Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Sridevi

Mandavelipakkam

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV
Elevators
24/7 Power Backup
Lobby
Rain Water Harvesting

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
10 5 4BHK + 3T 2245 South Available
4 2 4BHK + 3T 2245 South Available

Approvals

Planning Permit No:

OL- PP / NHRB / 0693 / 2024

Date of Permit:

2024-11-26

Building Permission No:

CEBA / WDCN09 / 00591 / 2024

Date of Permit:

2024-12-04

TNRERA:

TN/29/Building/0071/2025

Dated:

2025-03-10

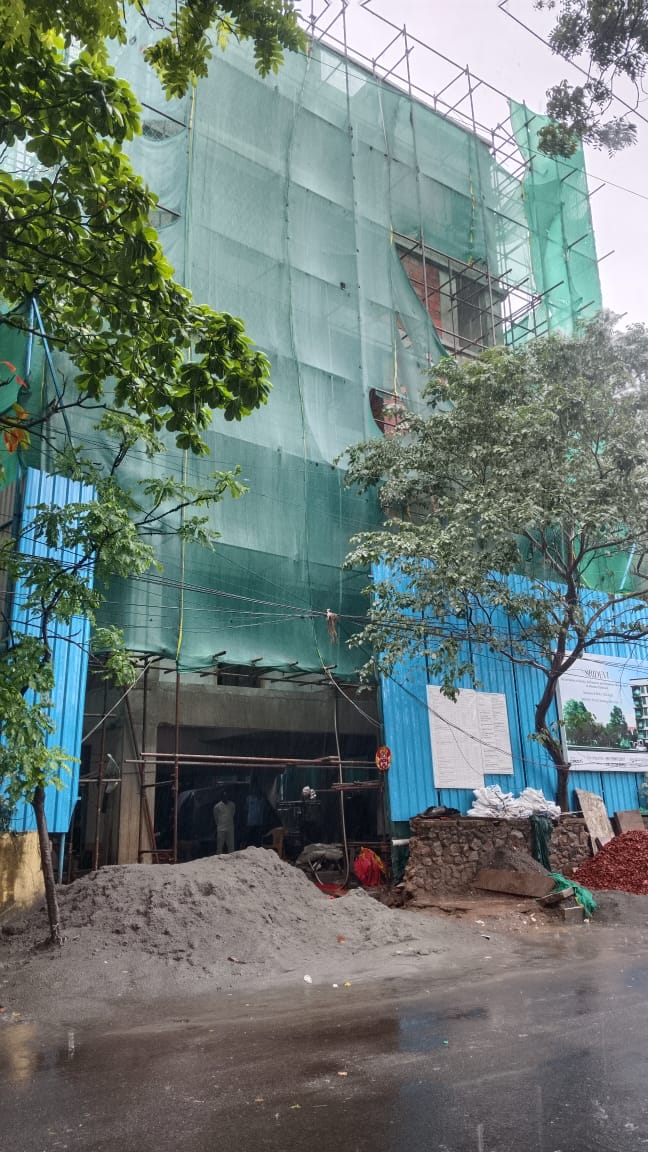

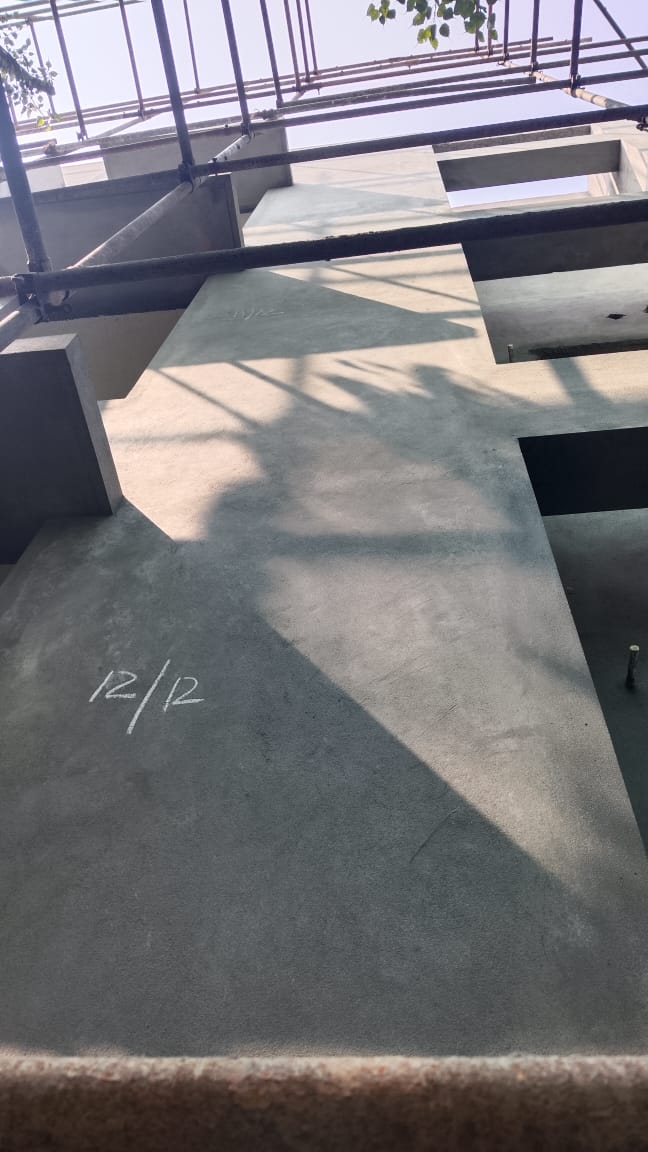

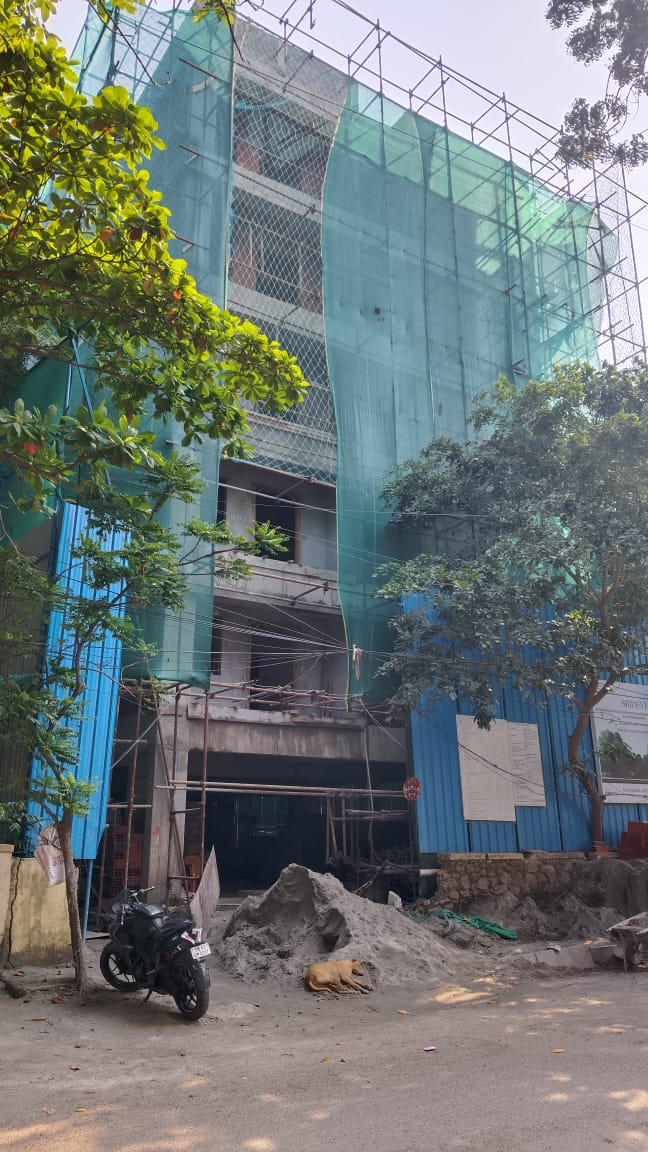

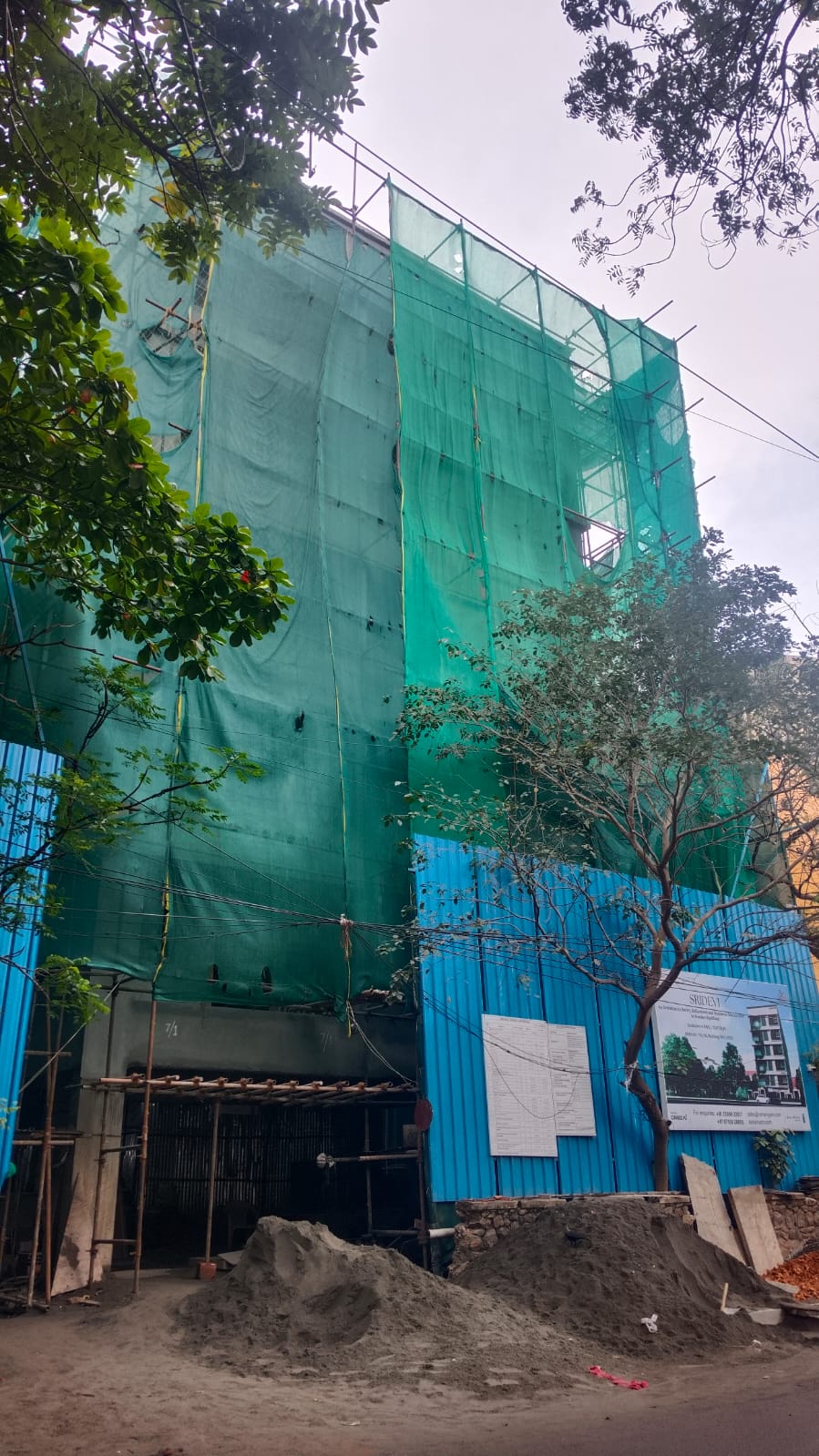

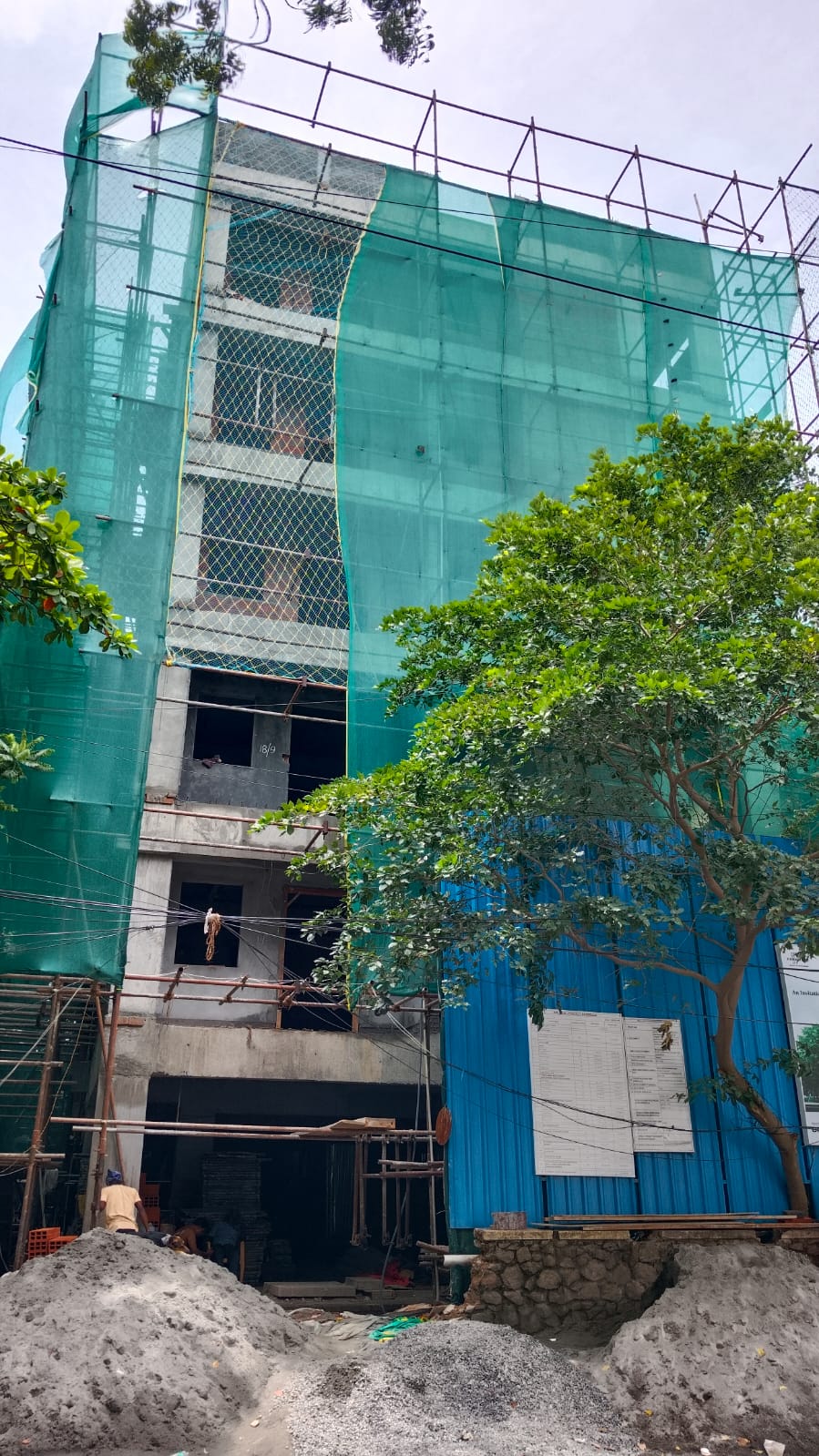

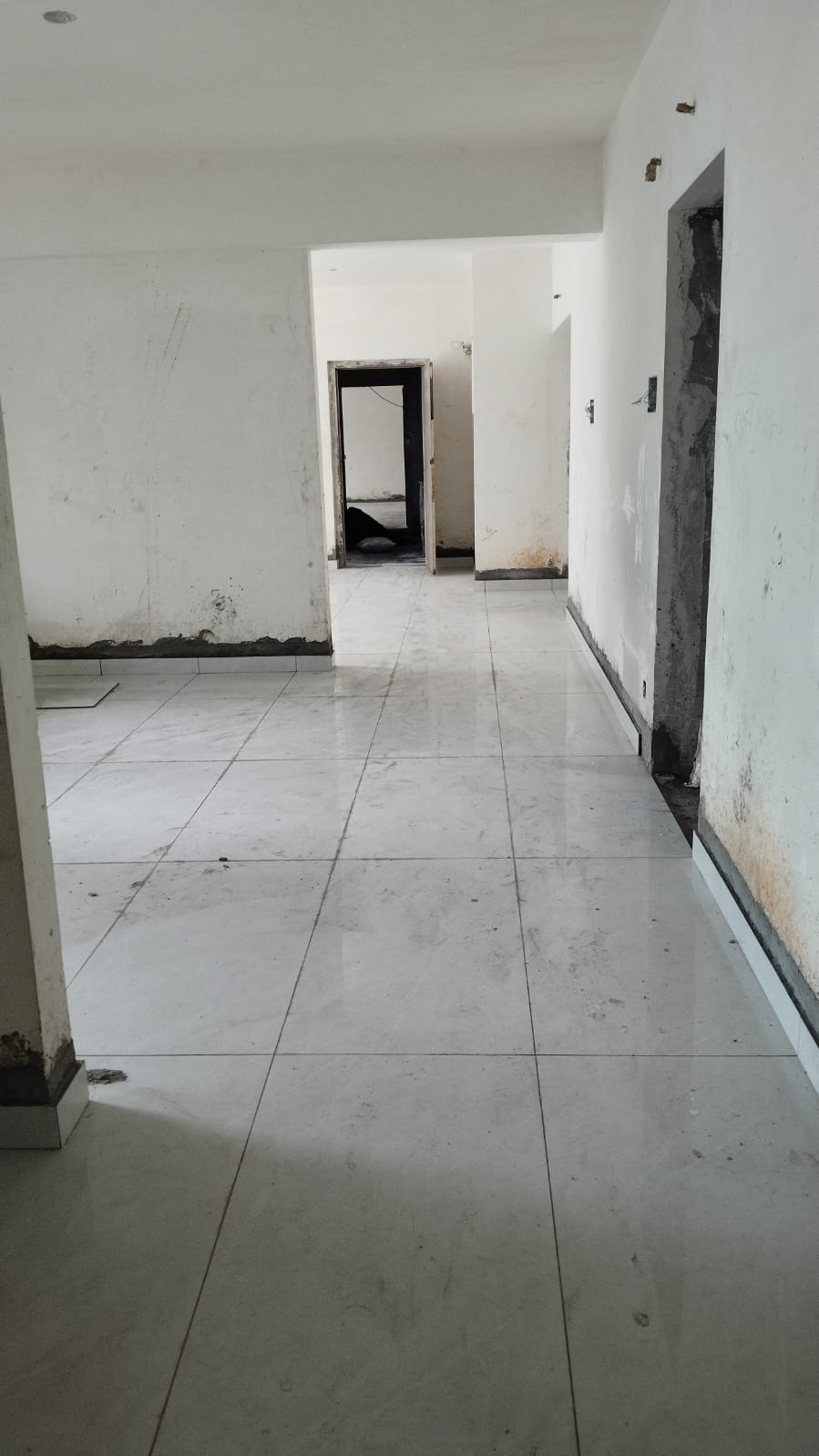

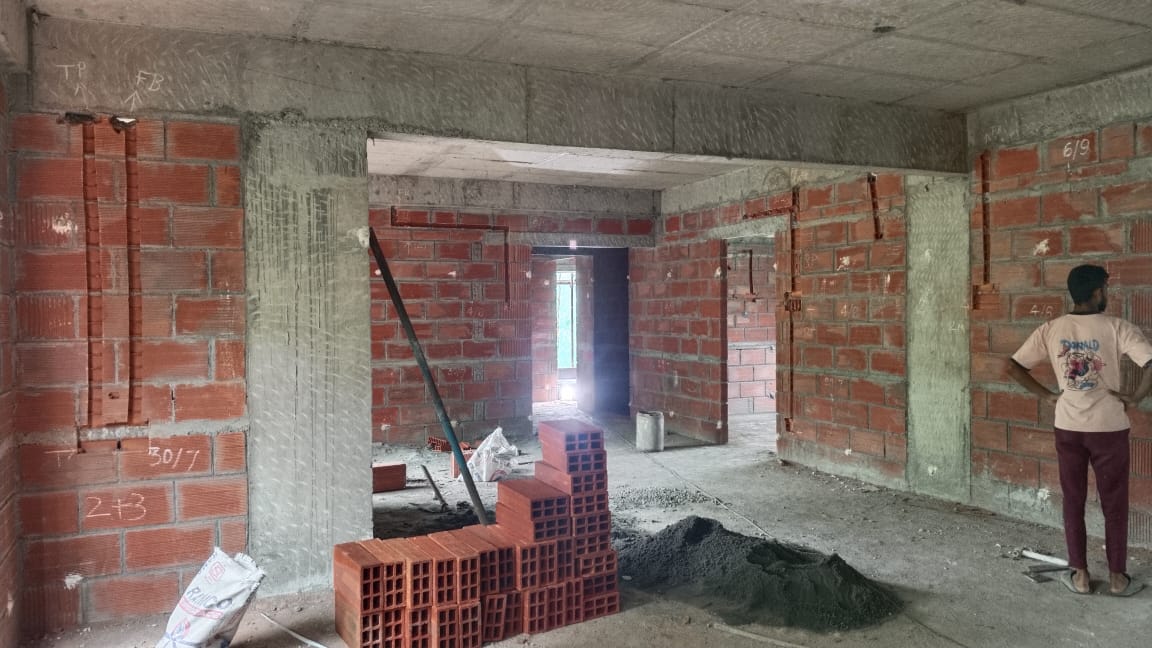

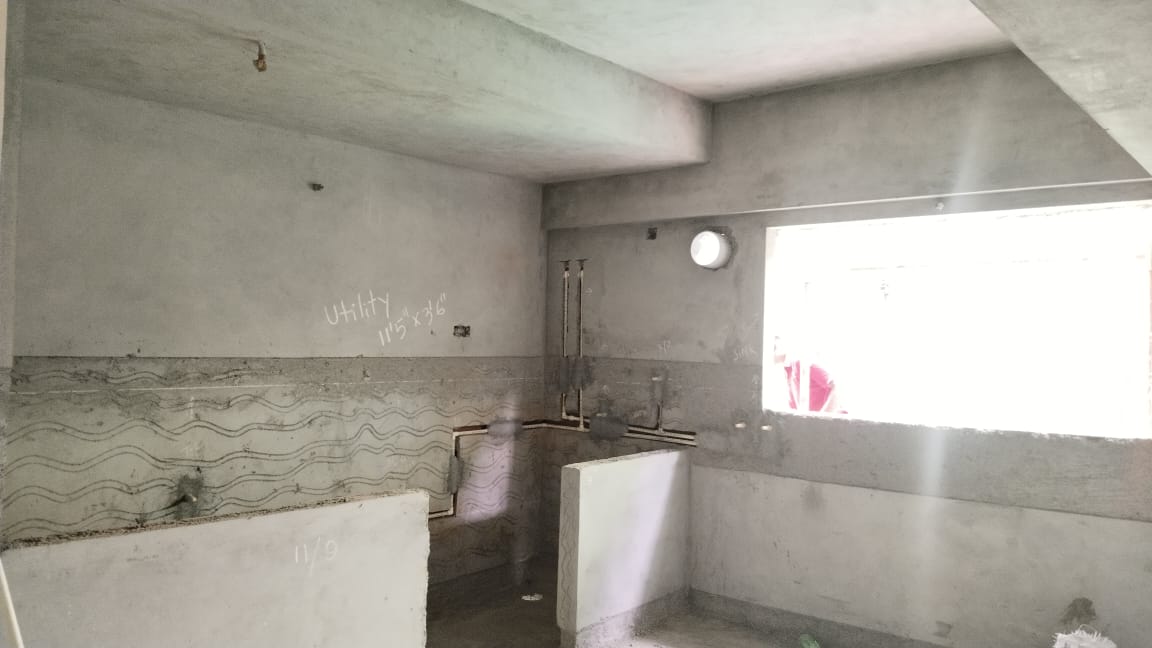

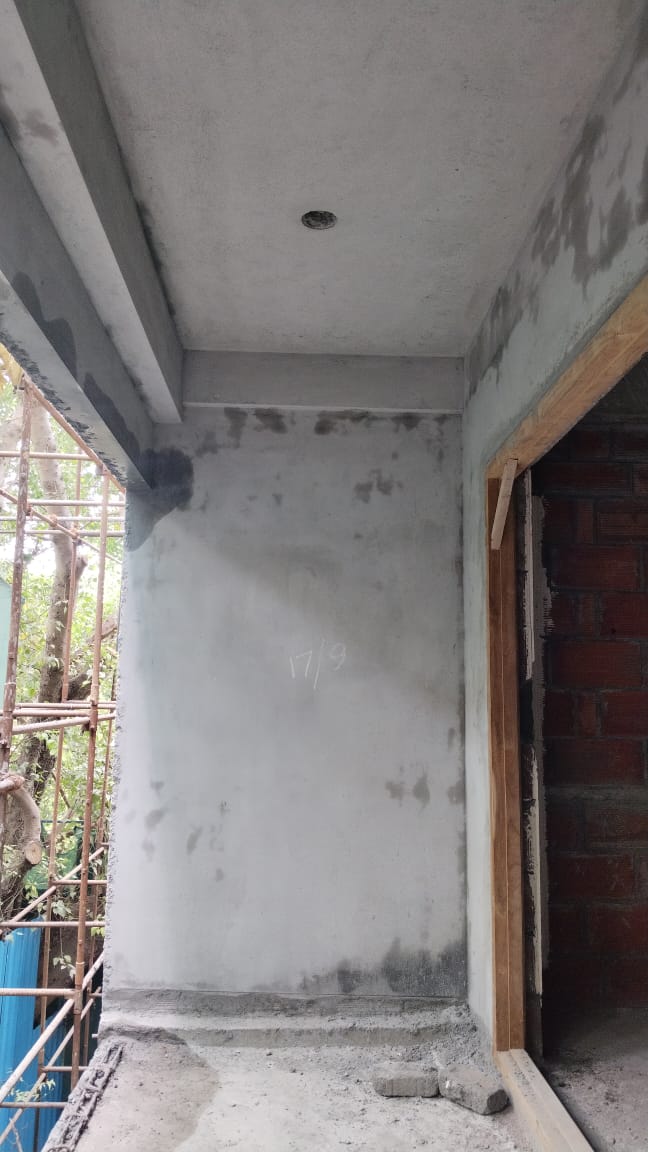

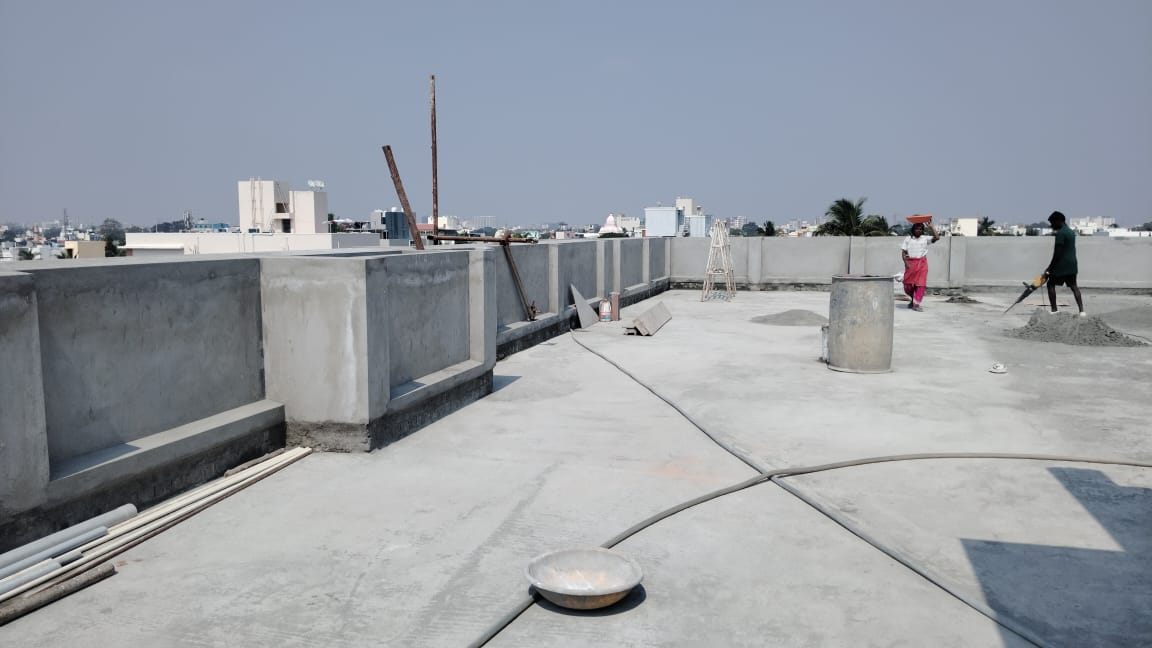

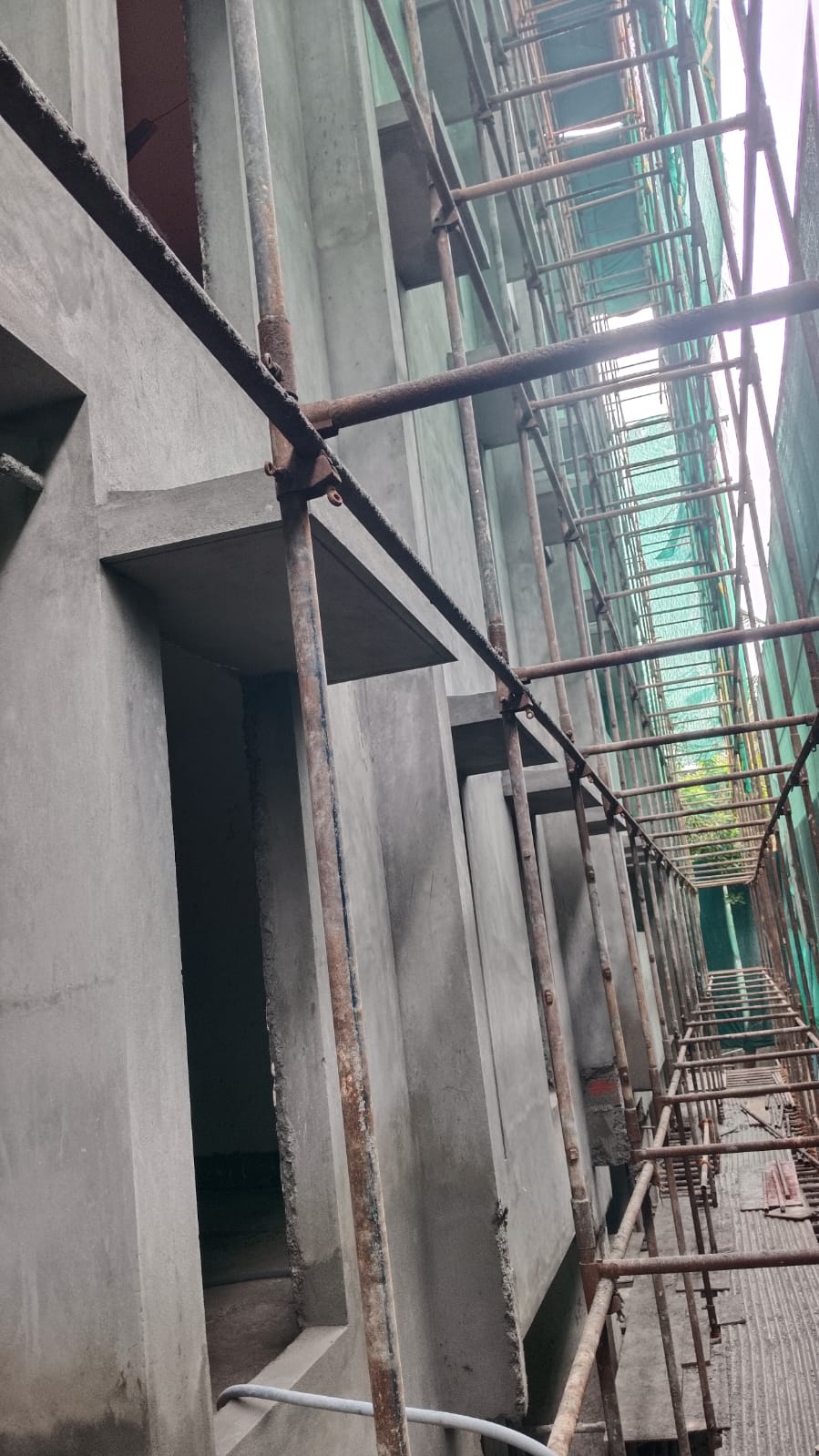

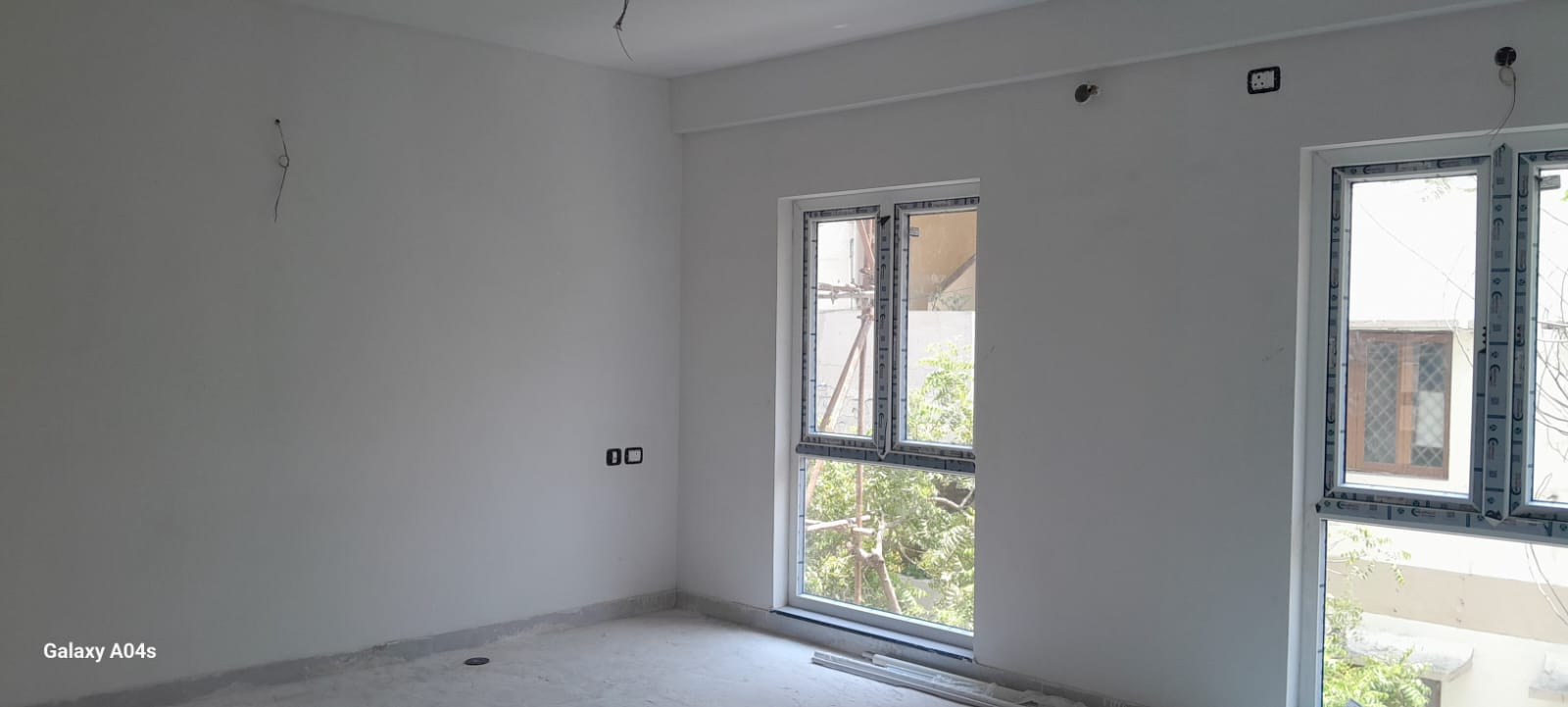

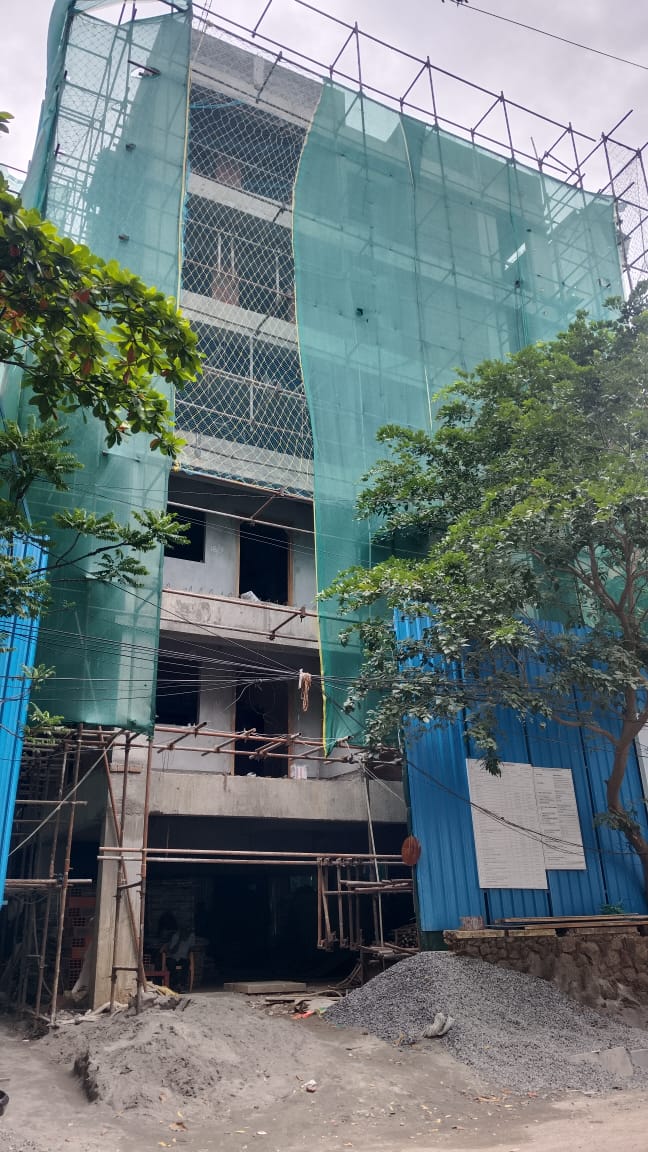

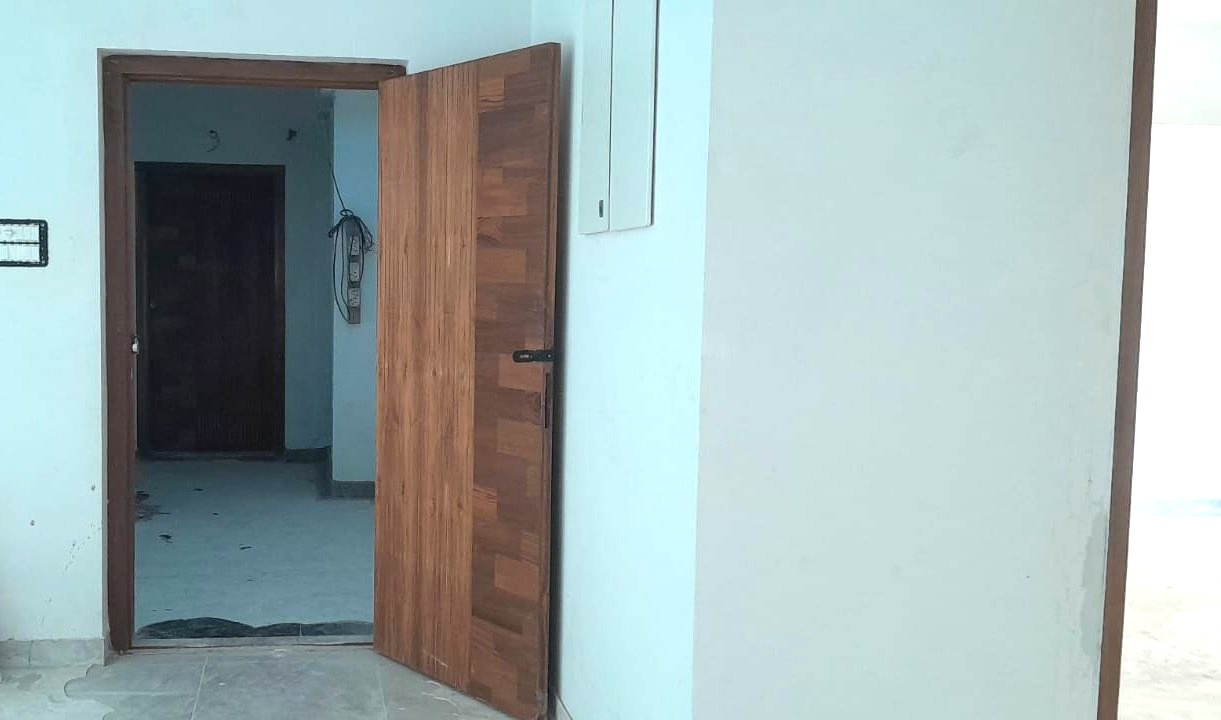

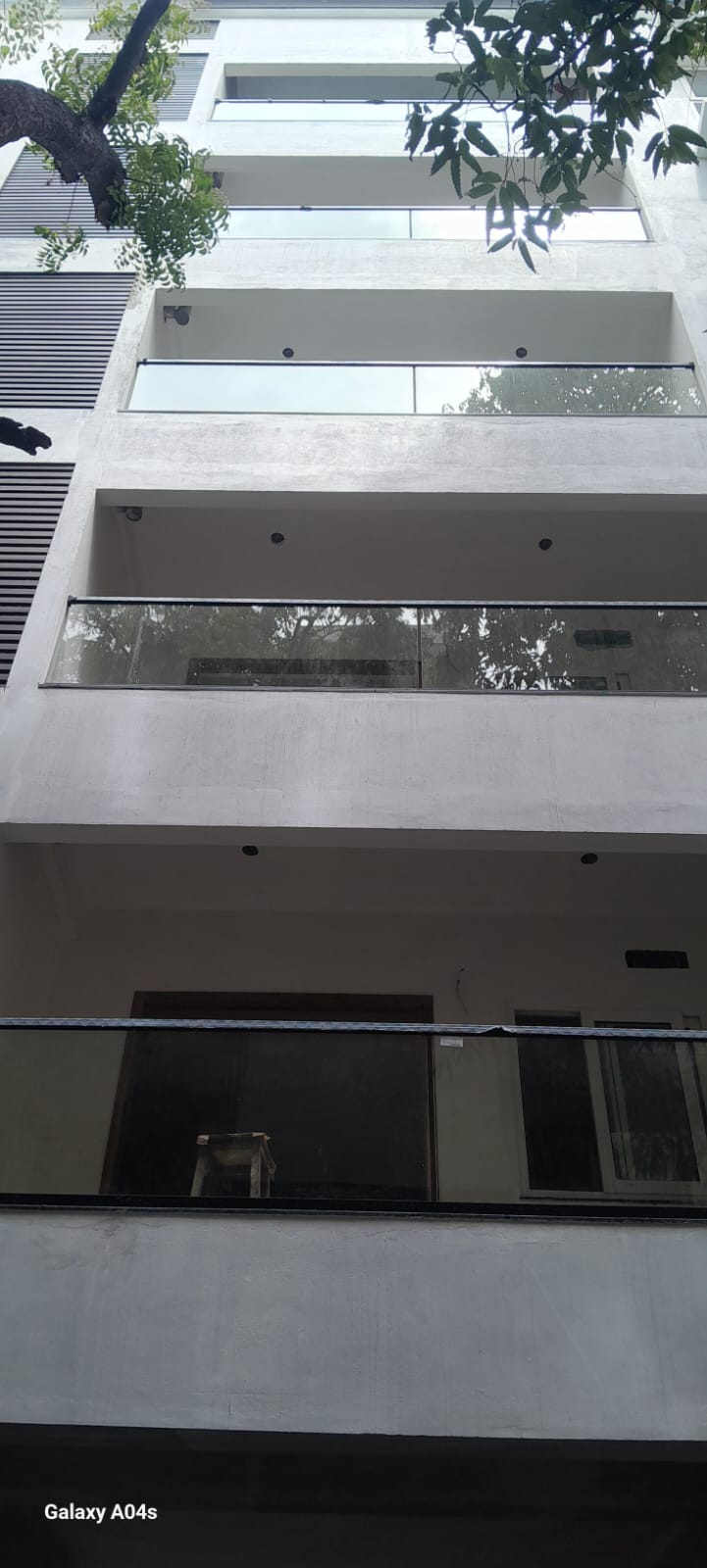

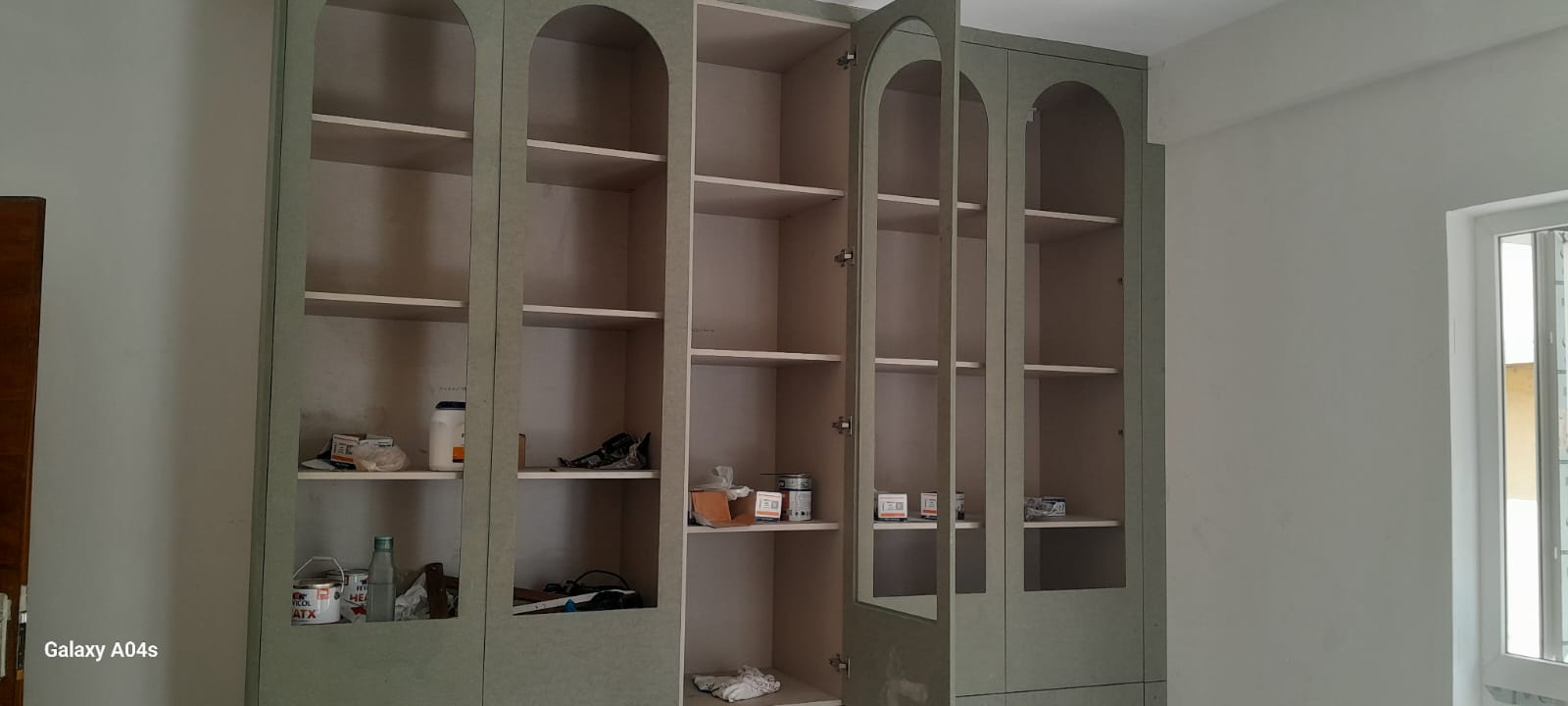

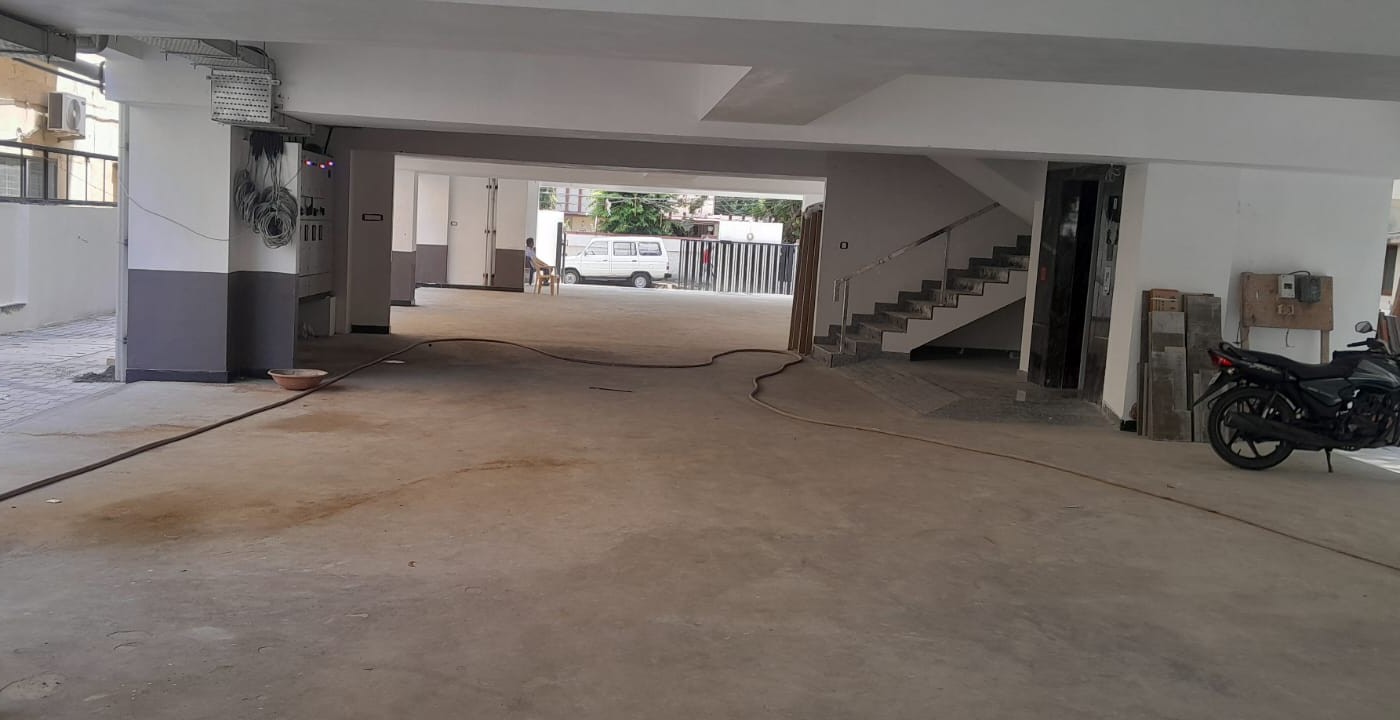

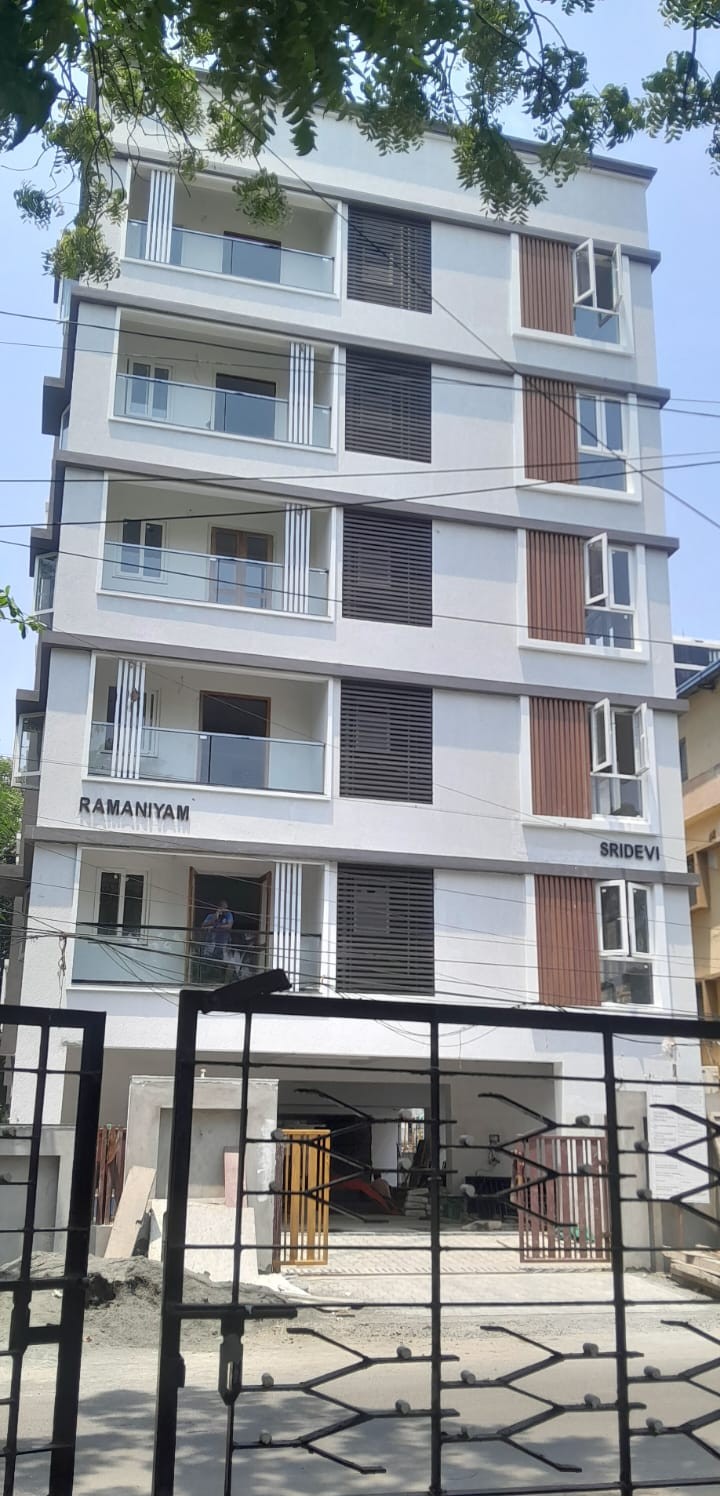

Project Update Images

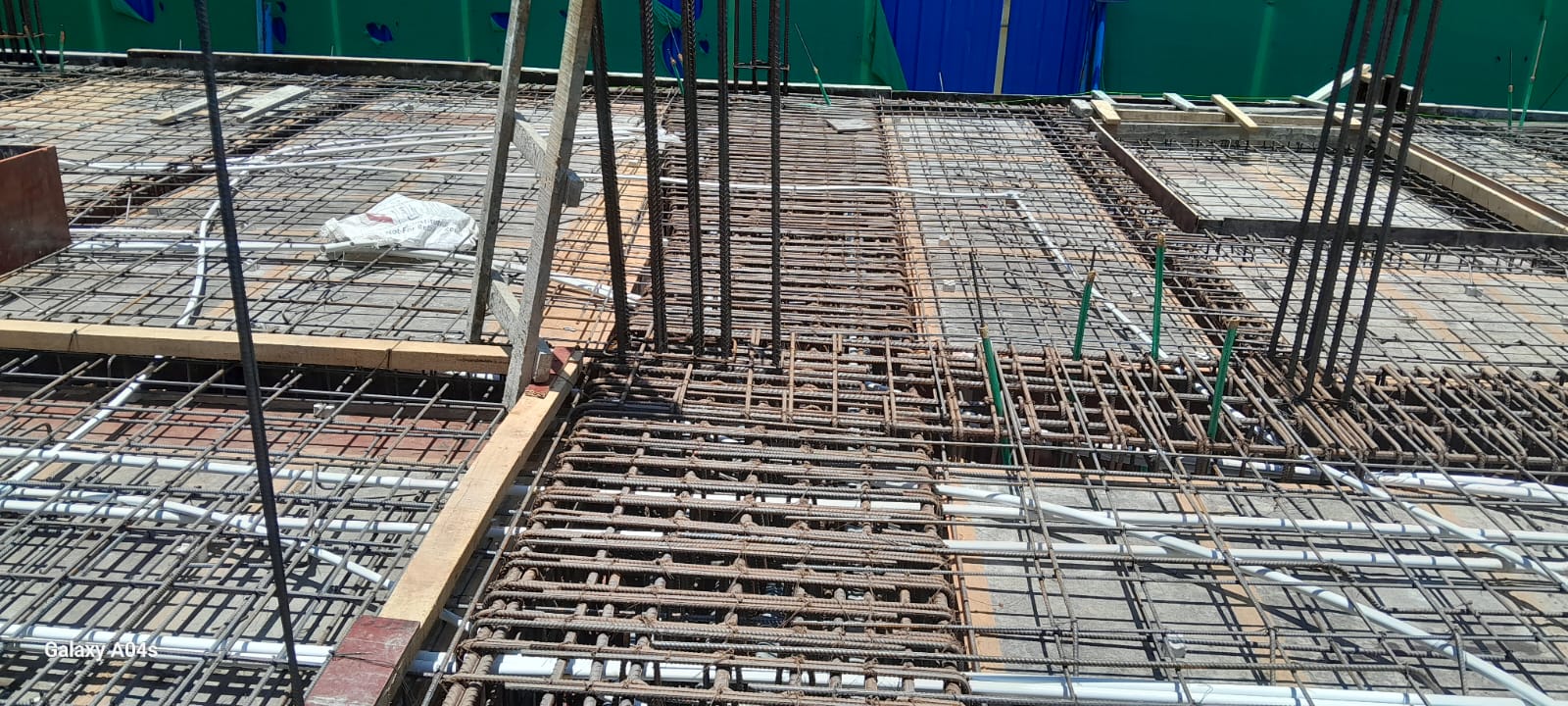

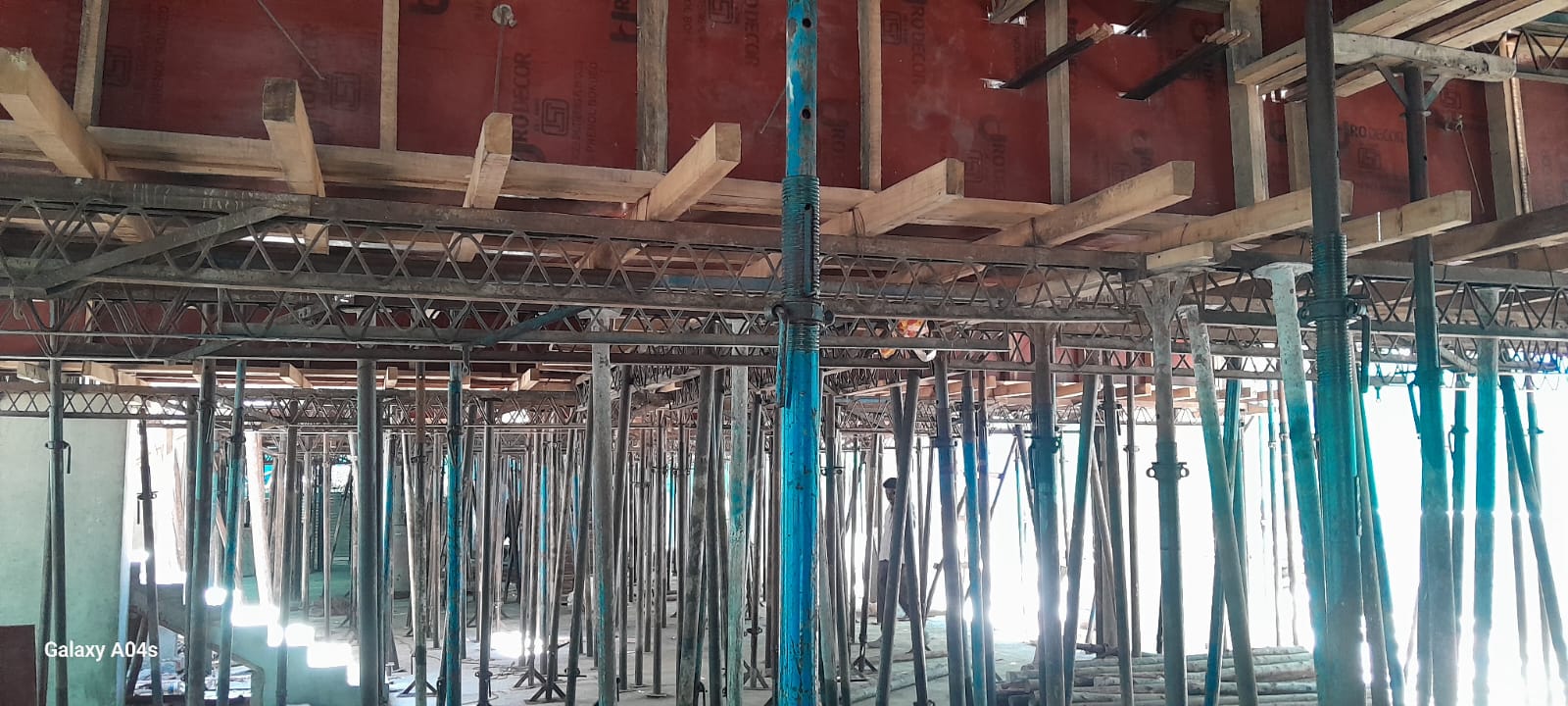

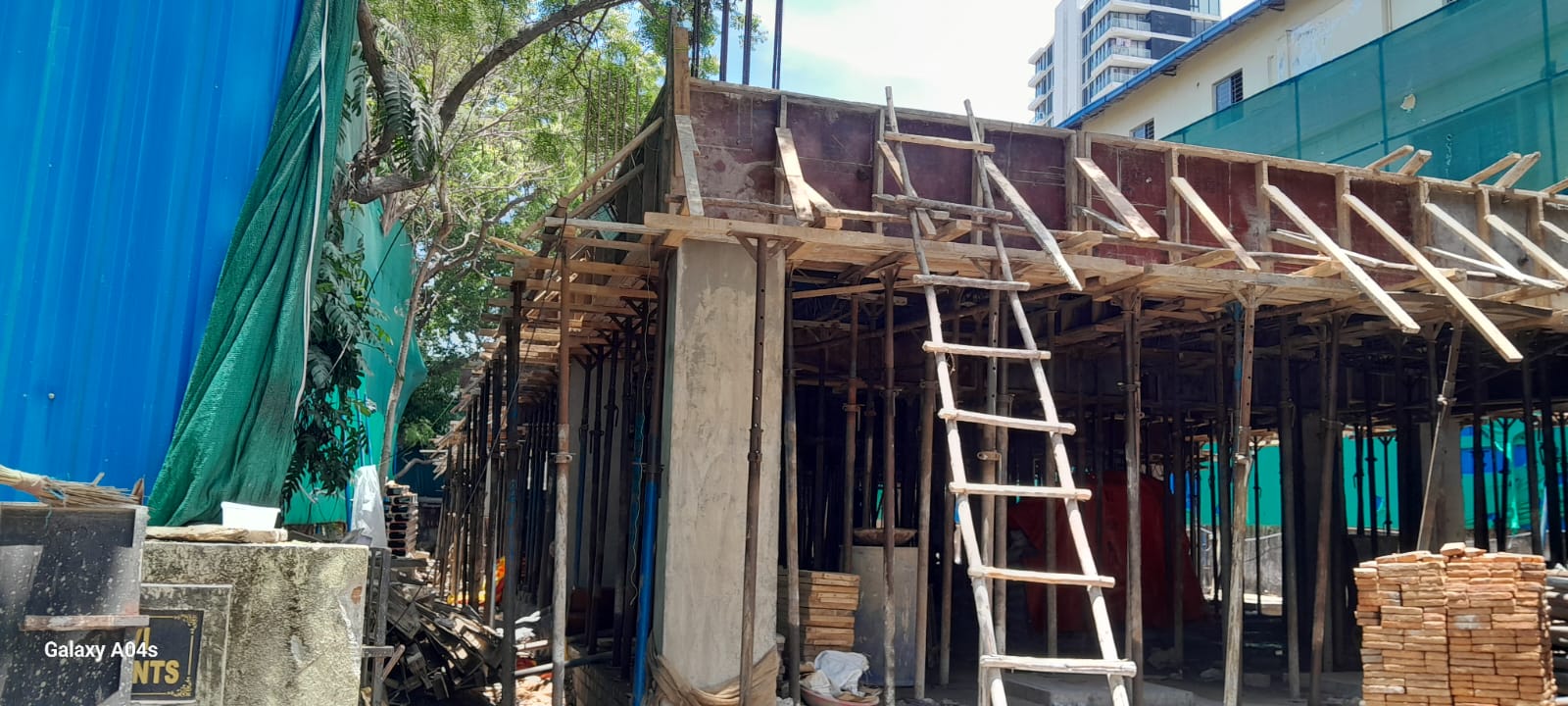

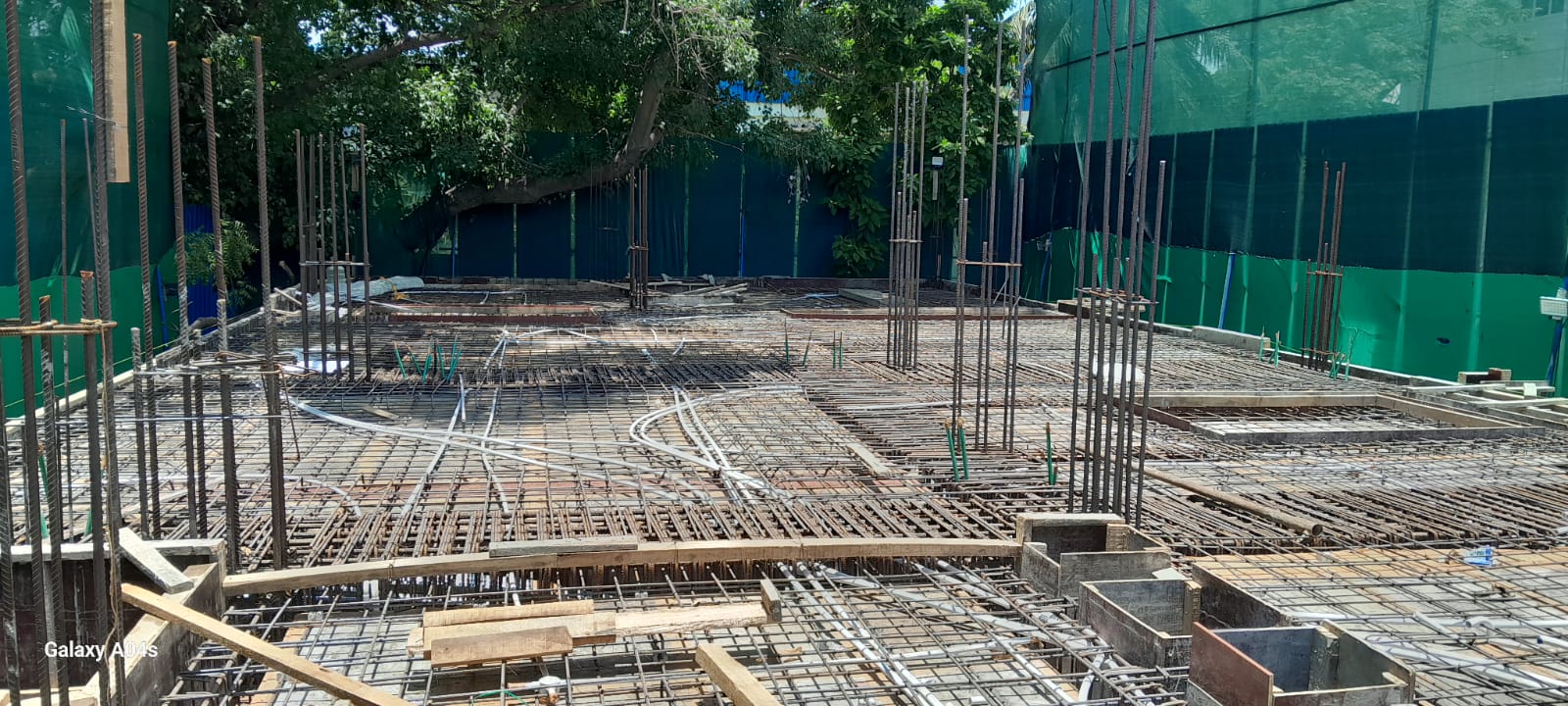

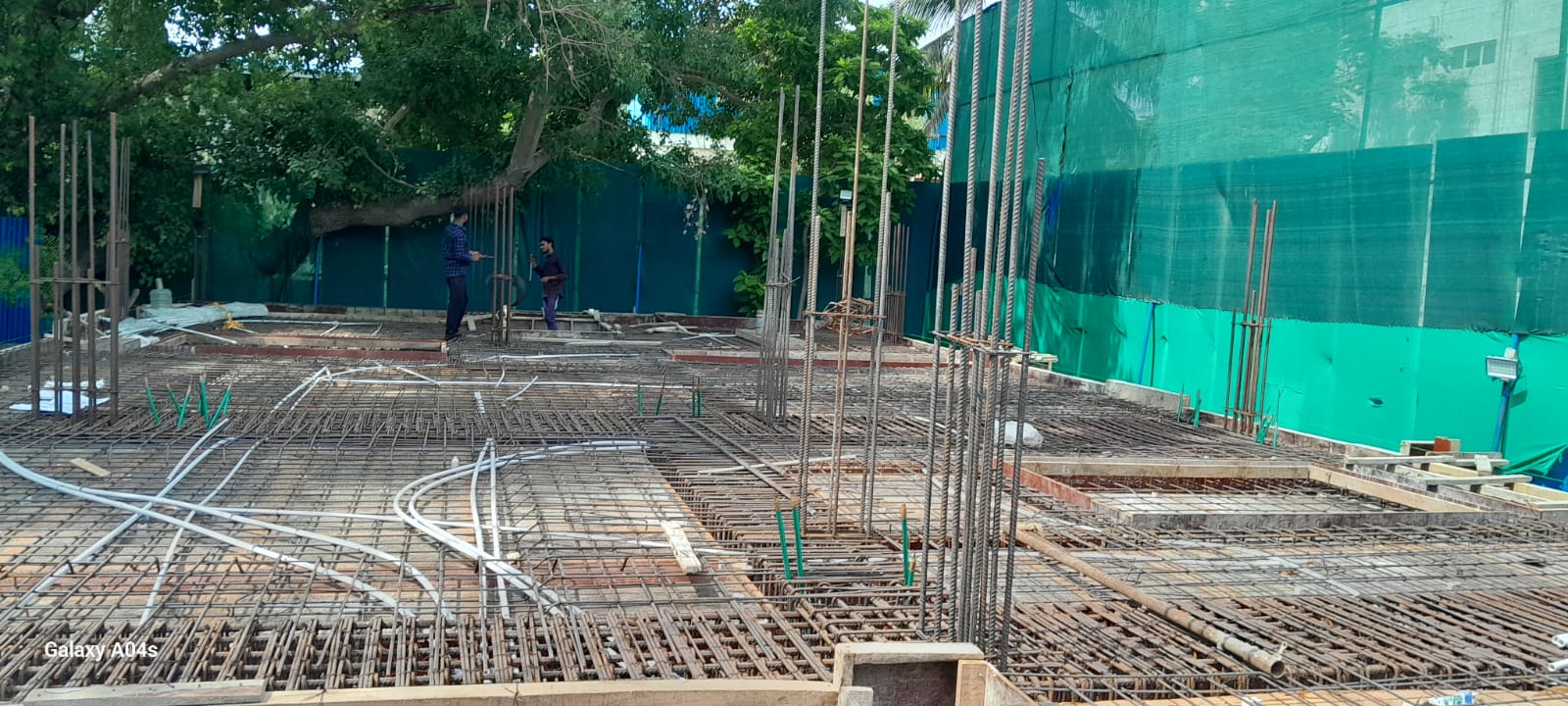

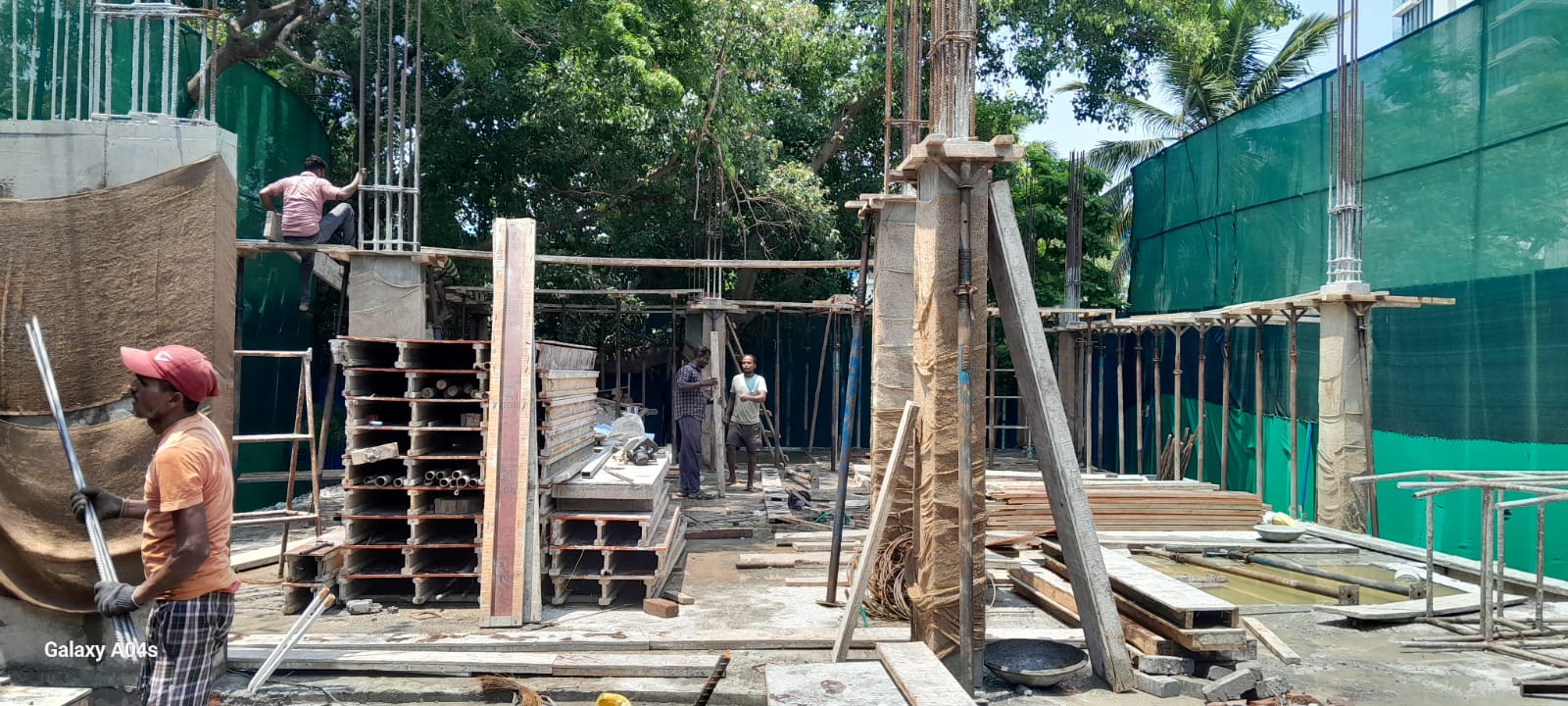

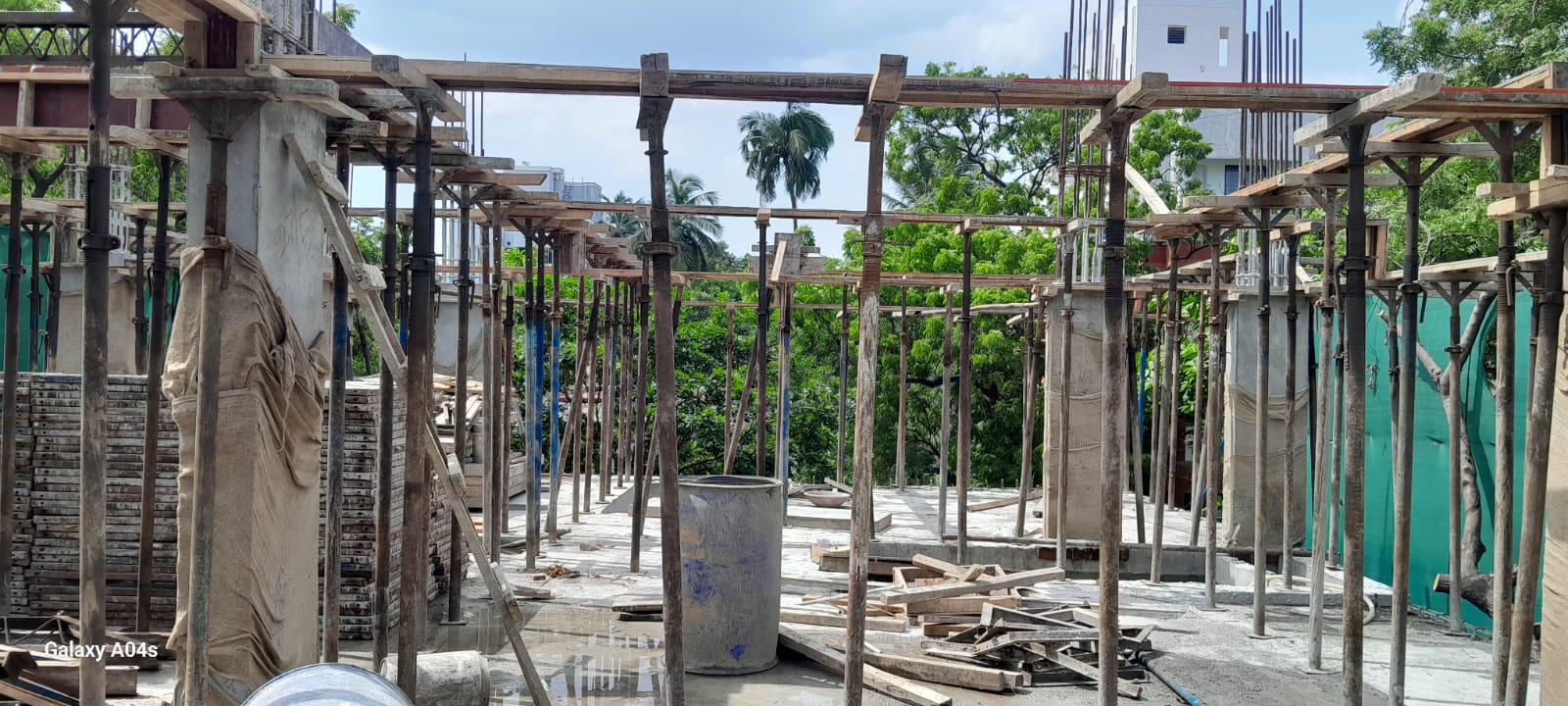

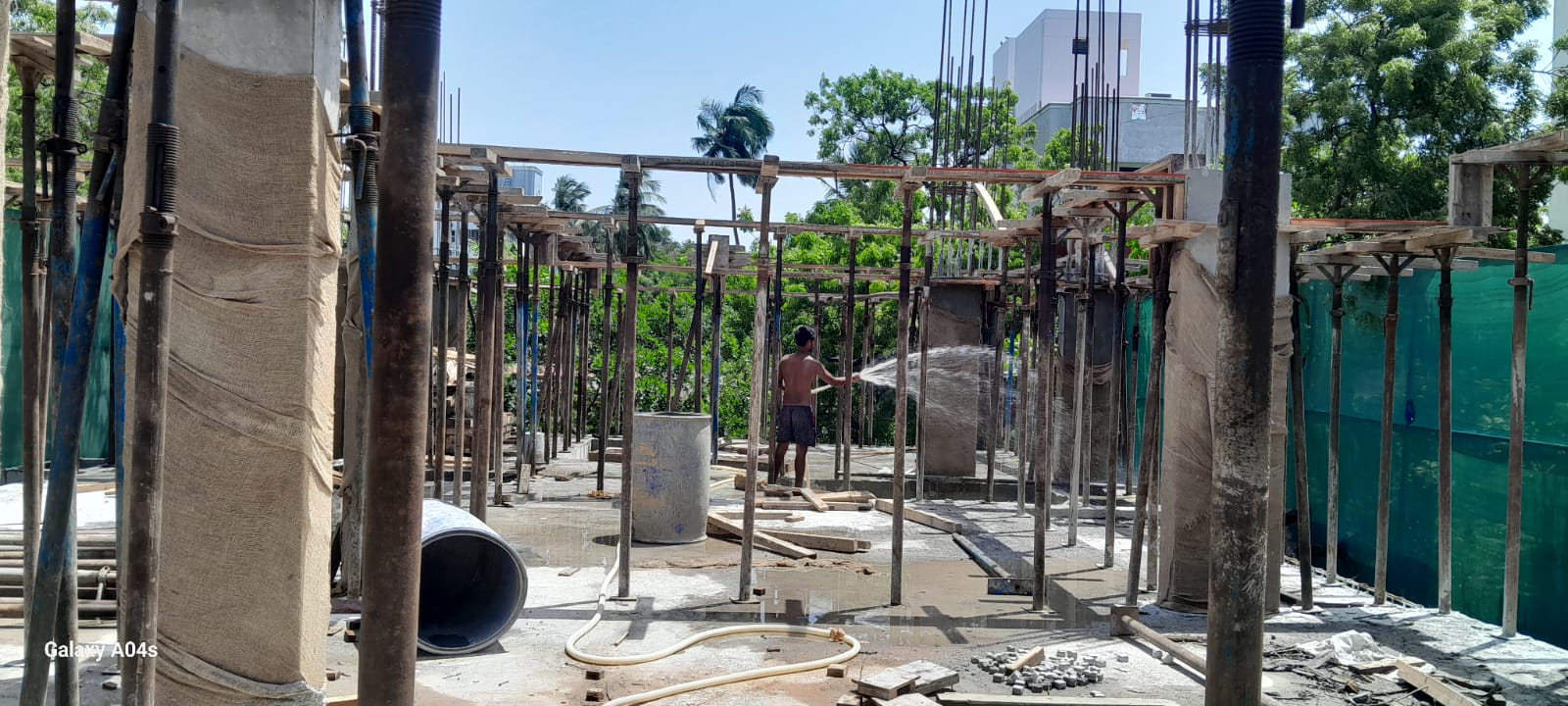

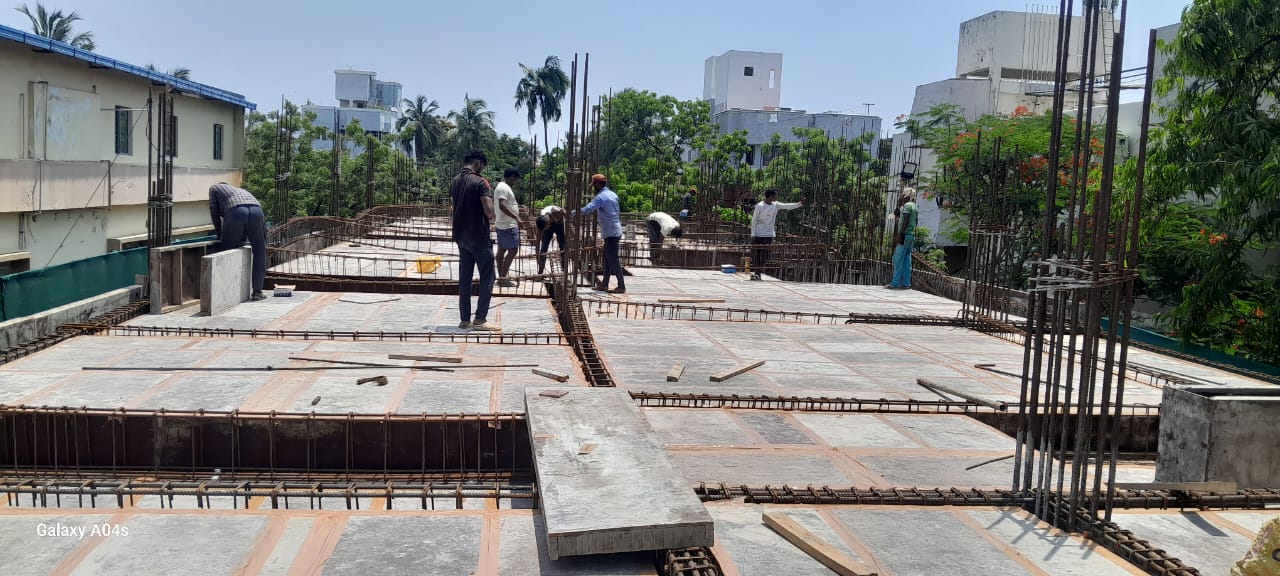

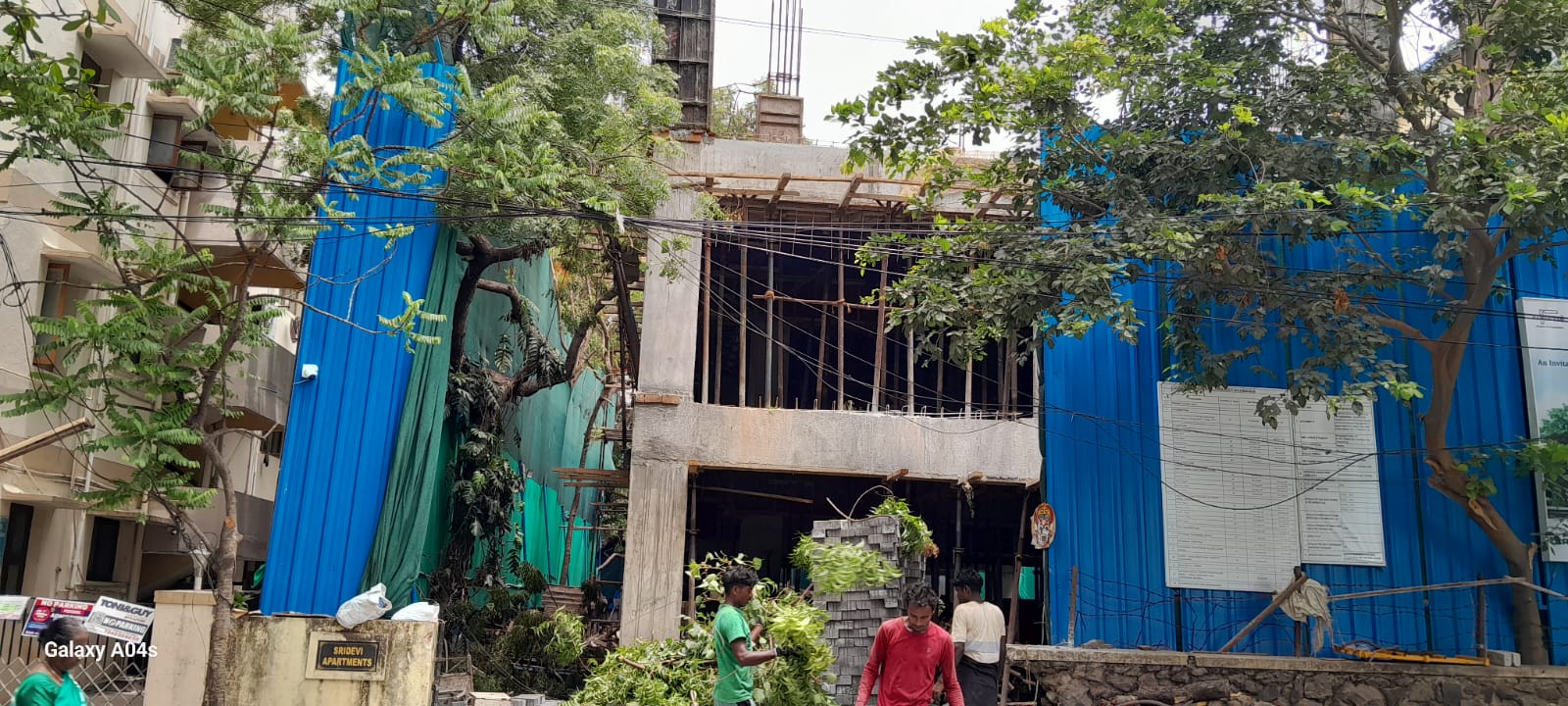

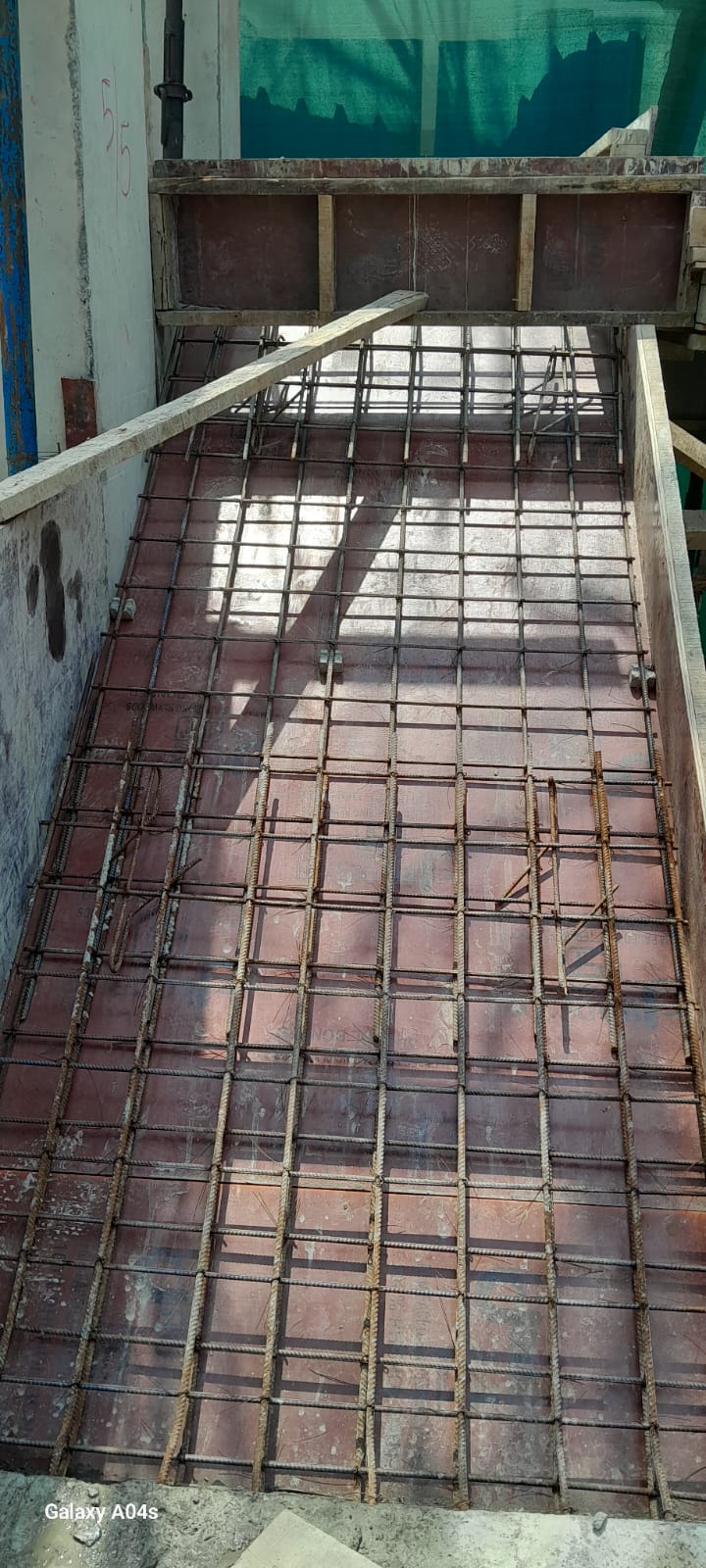

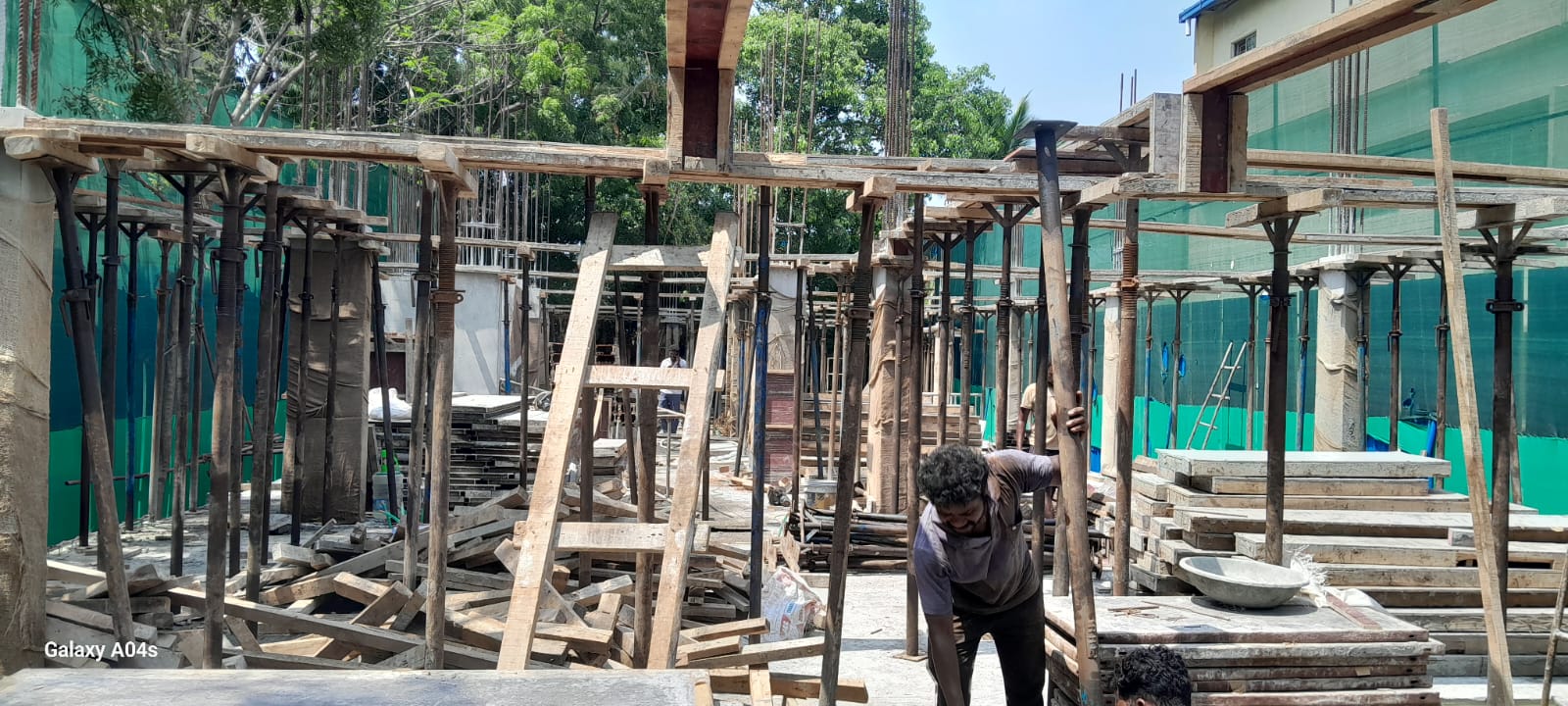

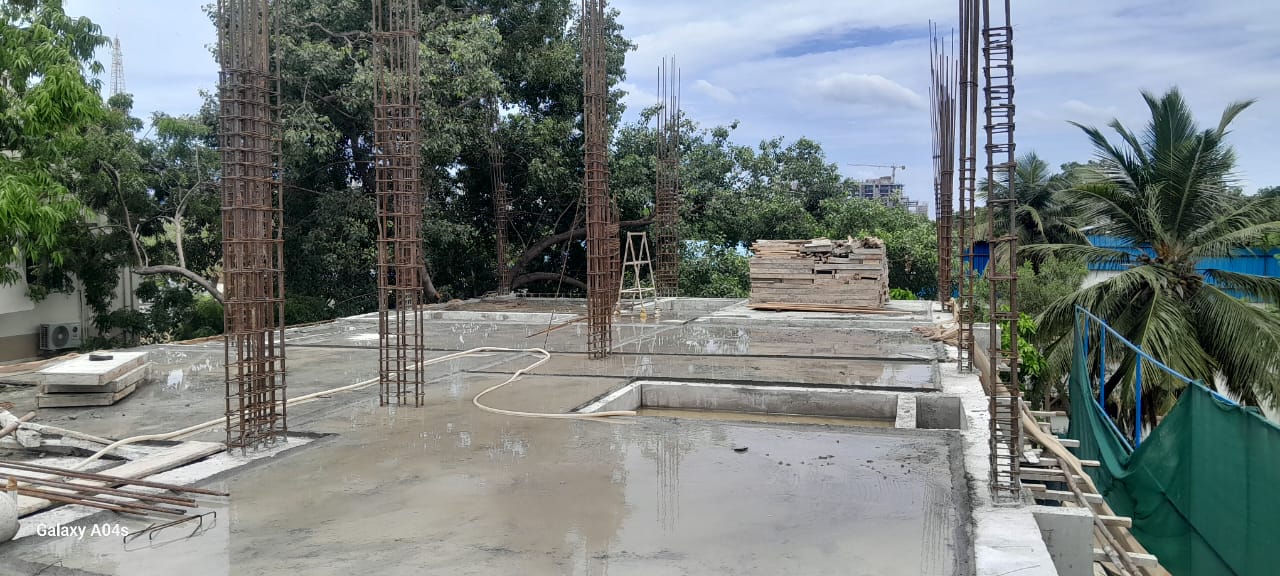

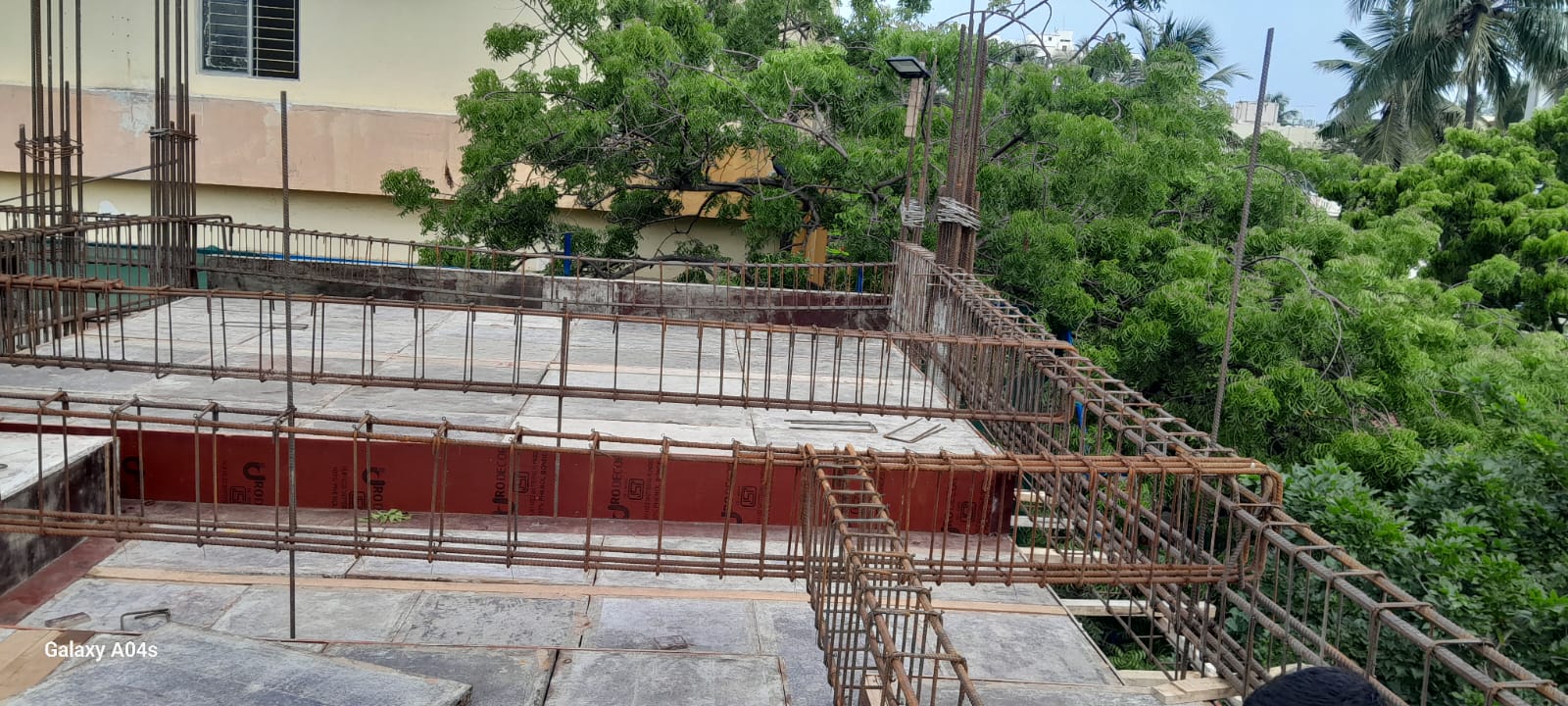

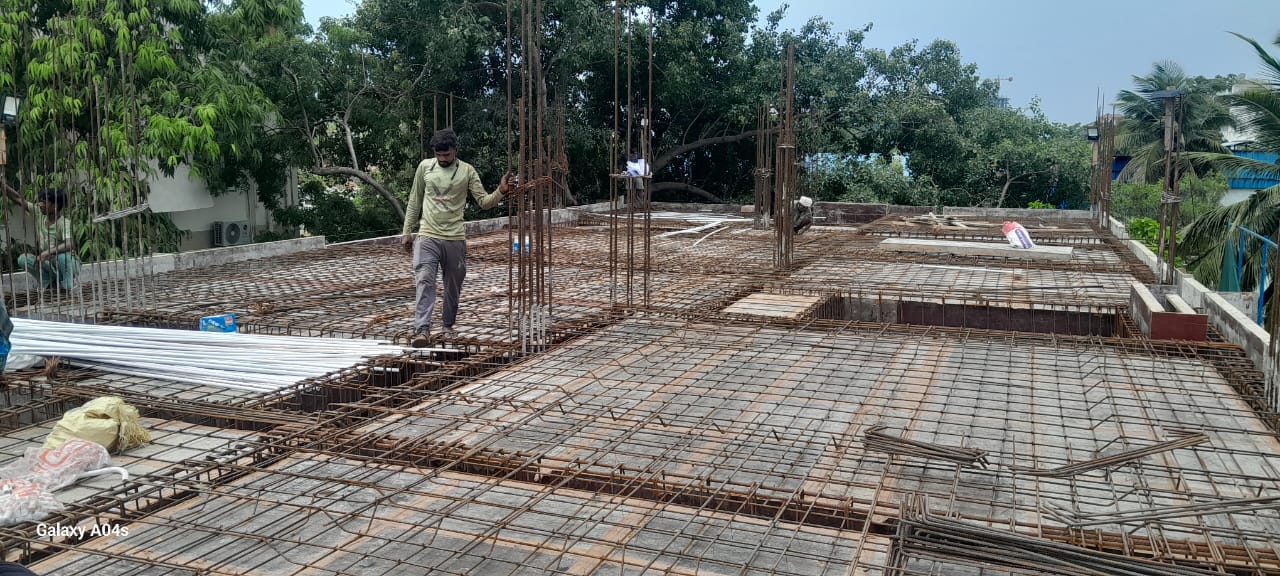

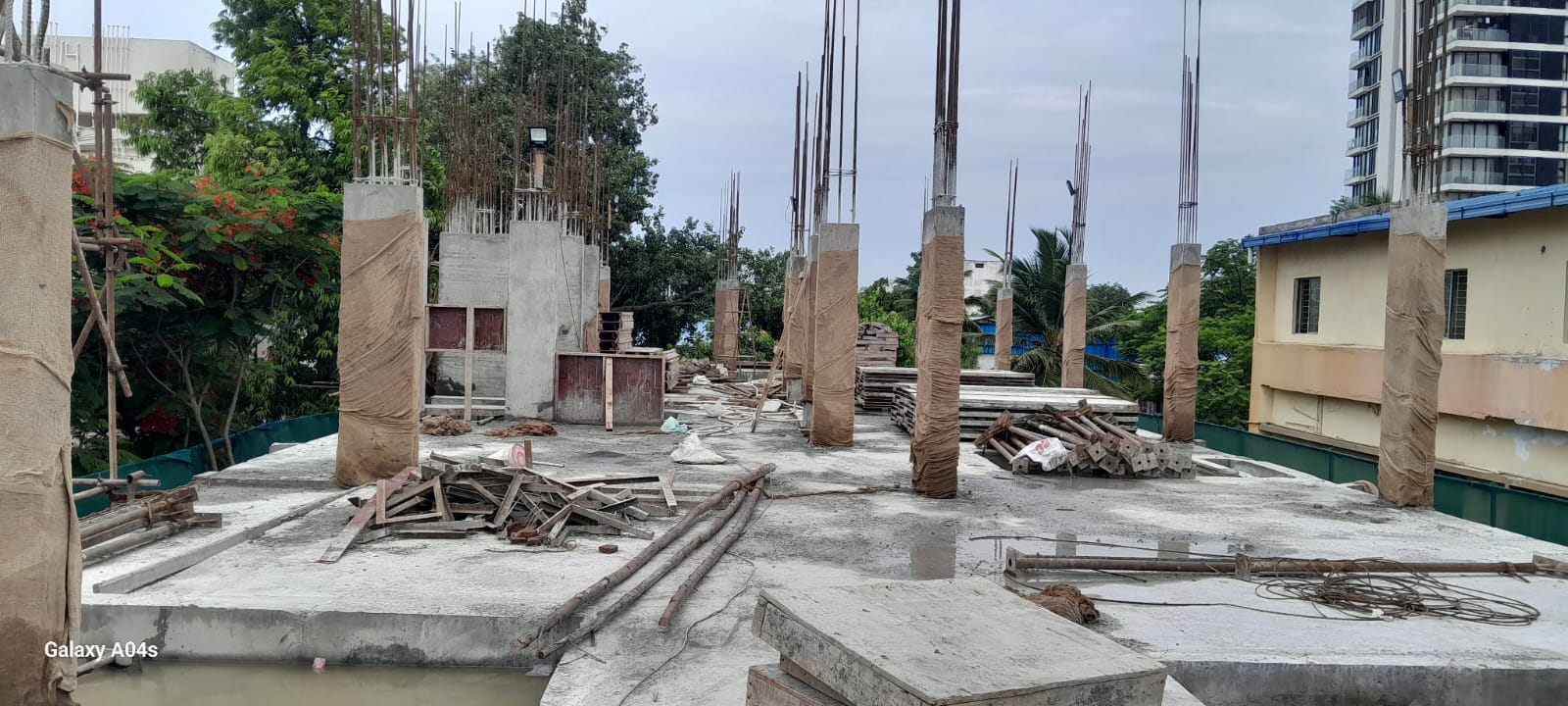

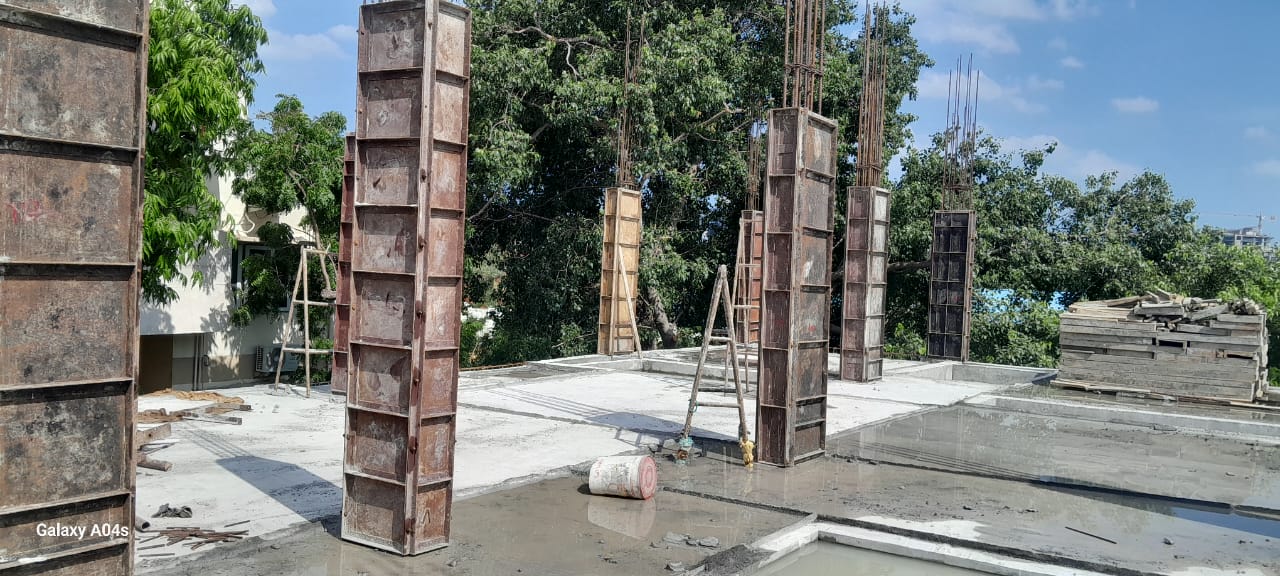

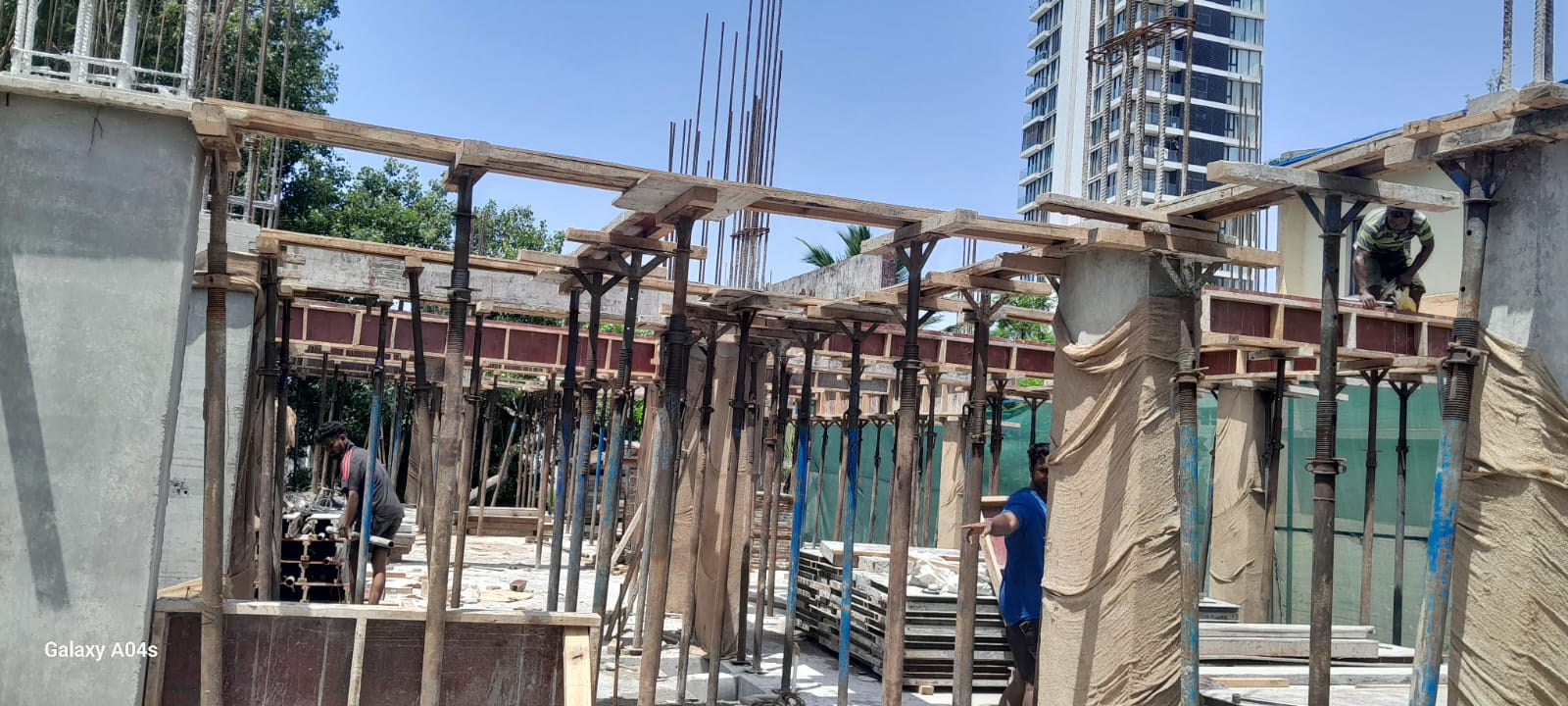

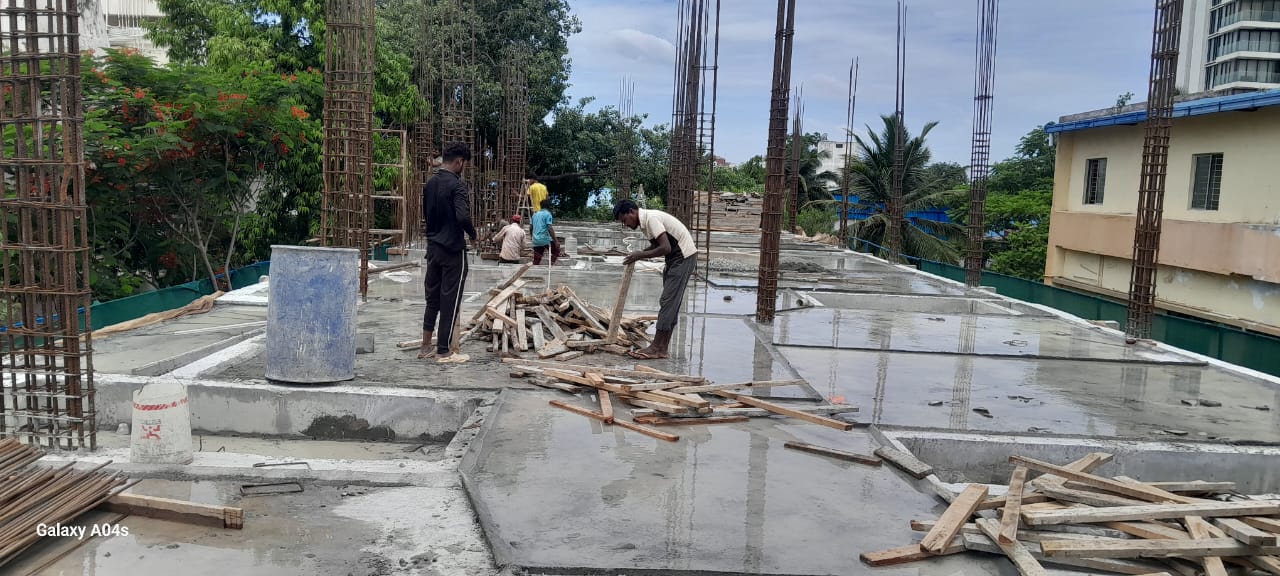

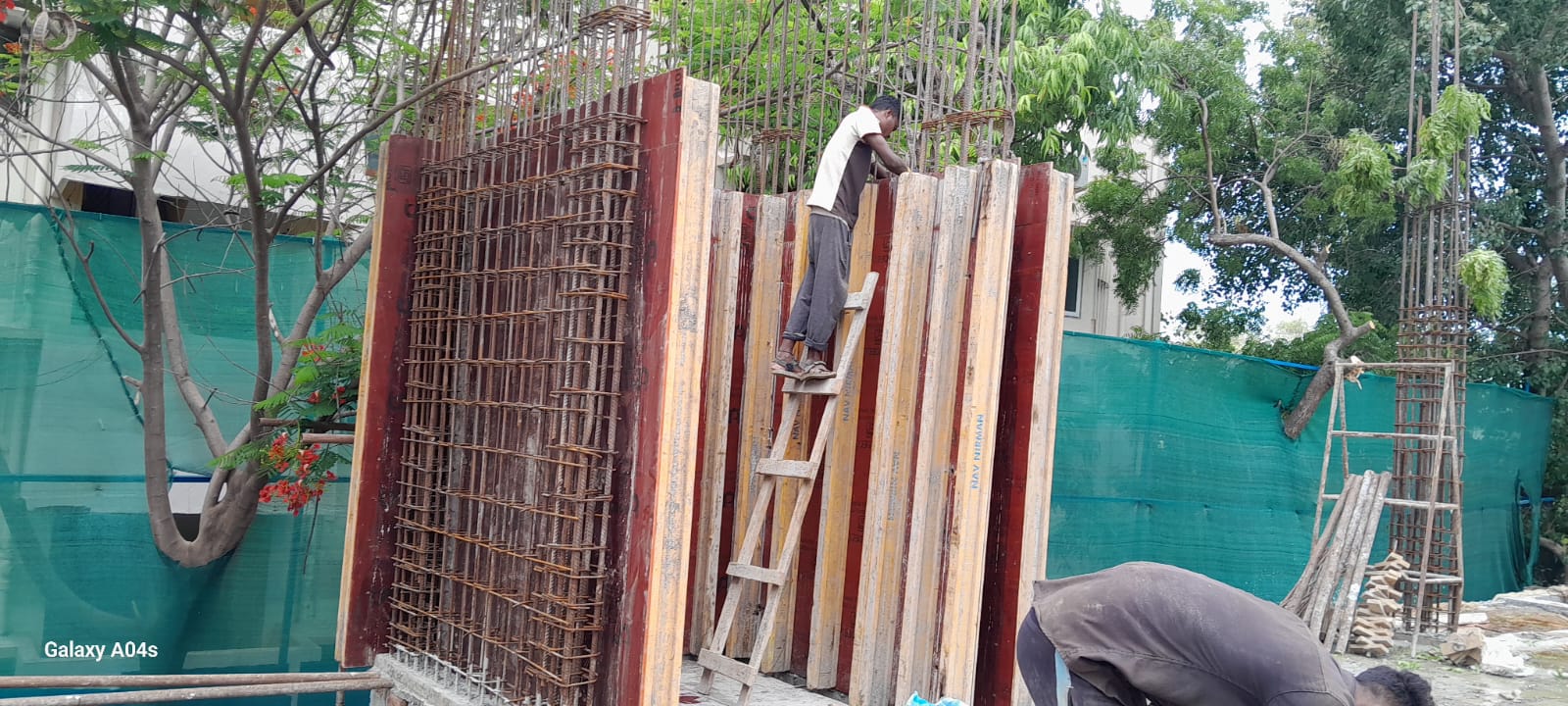

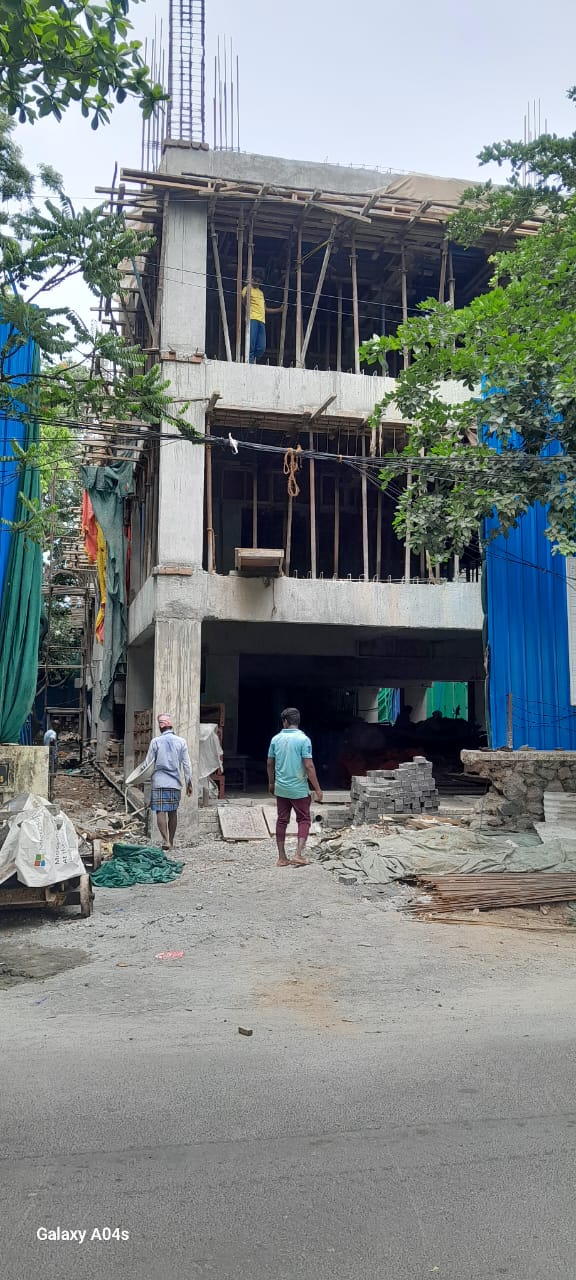

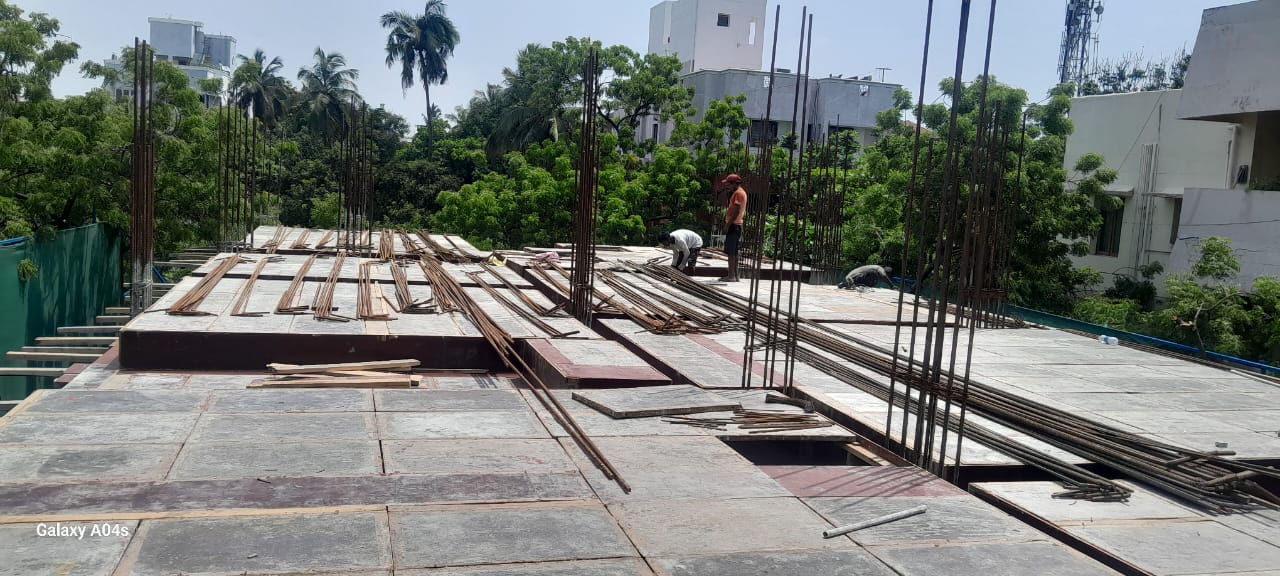

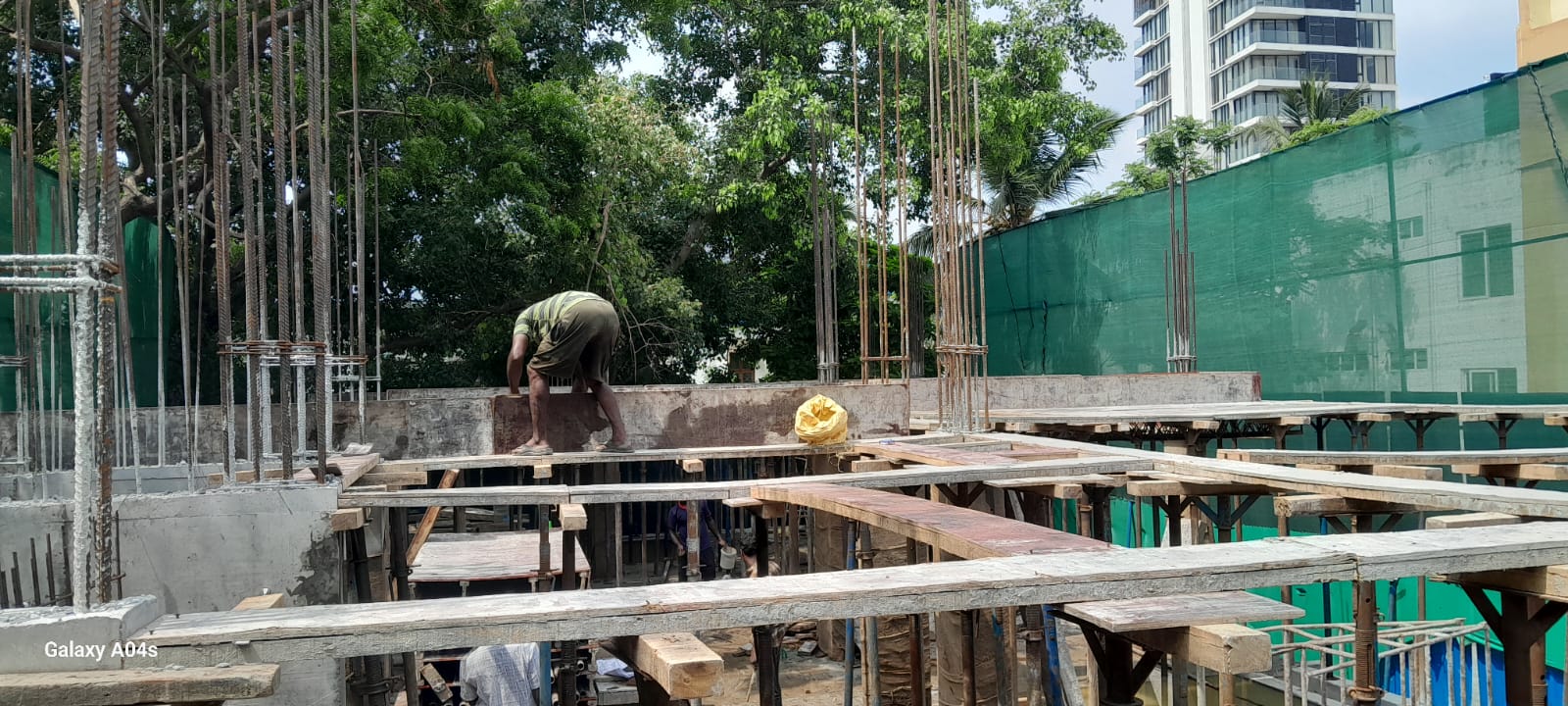

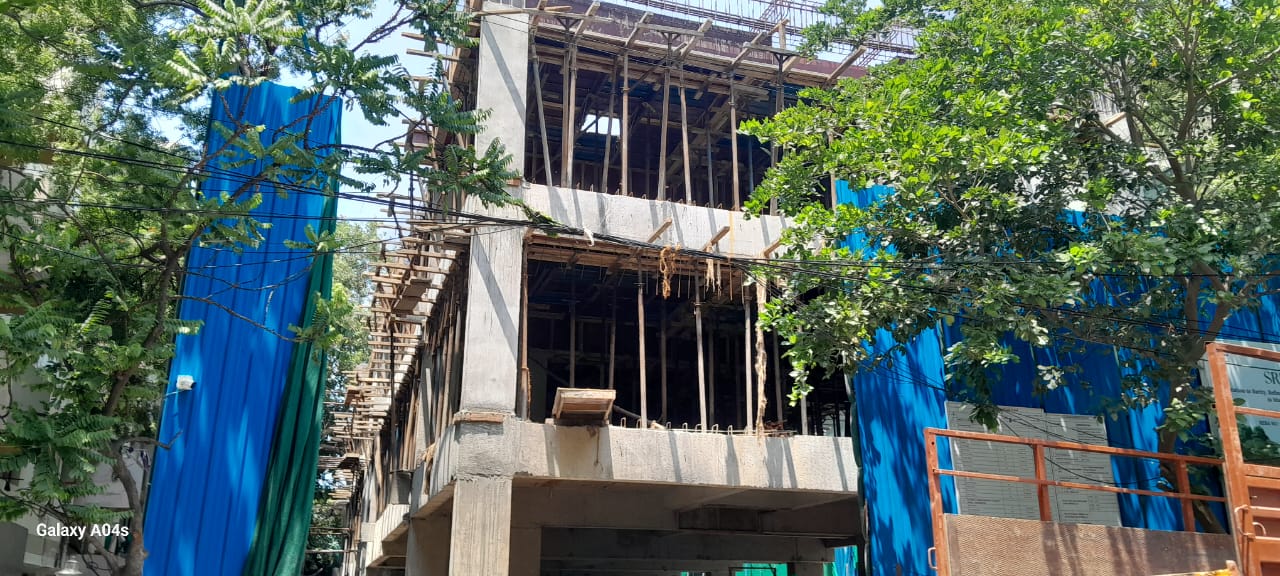

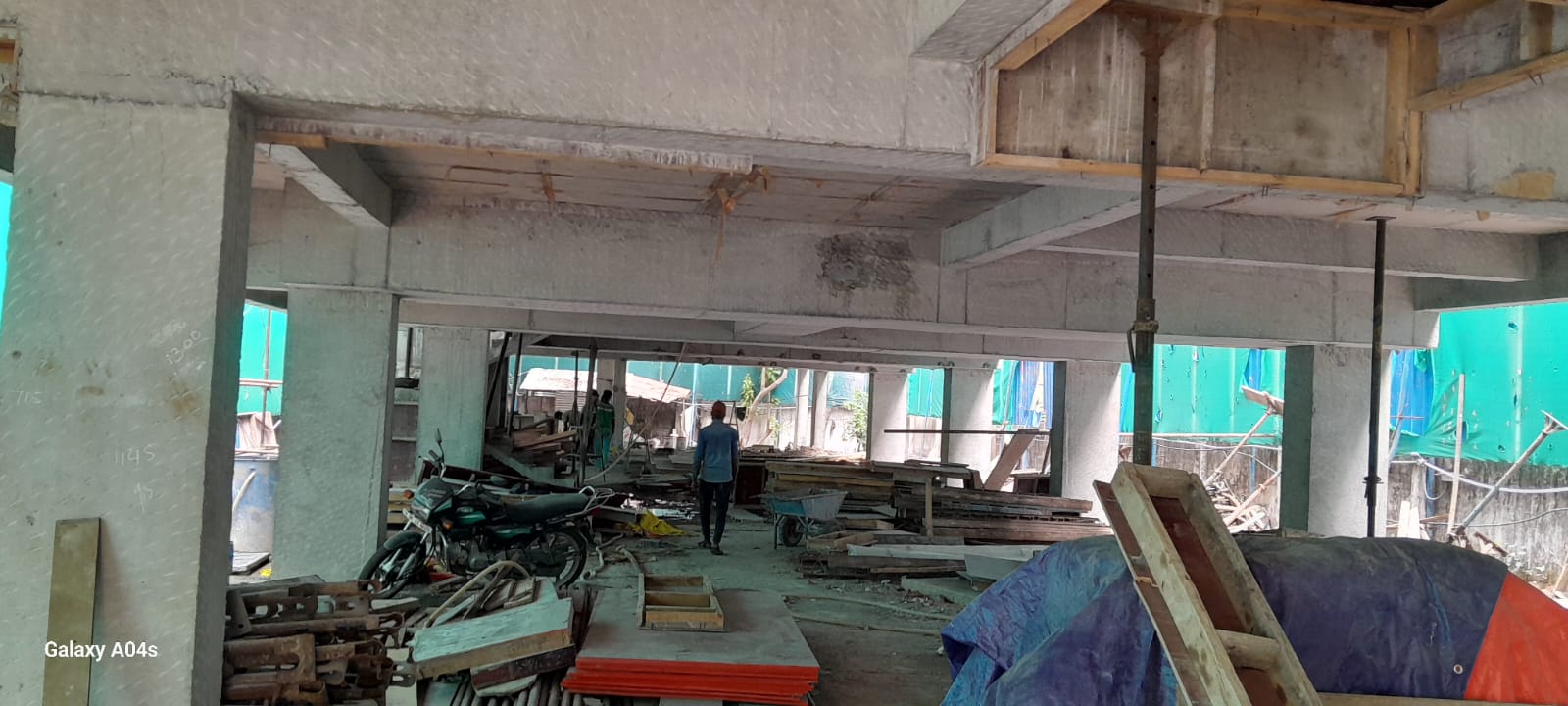

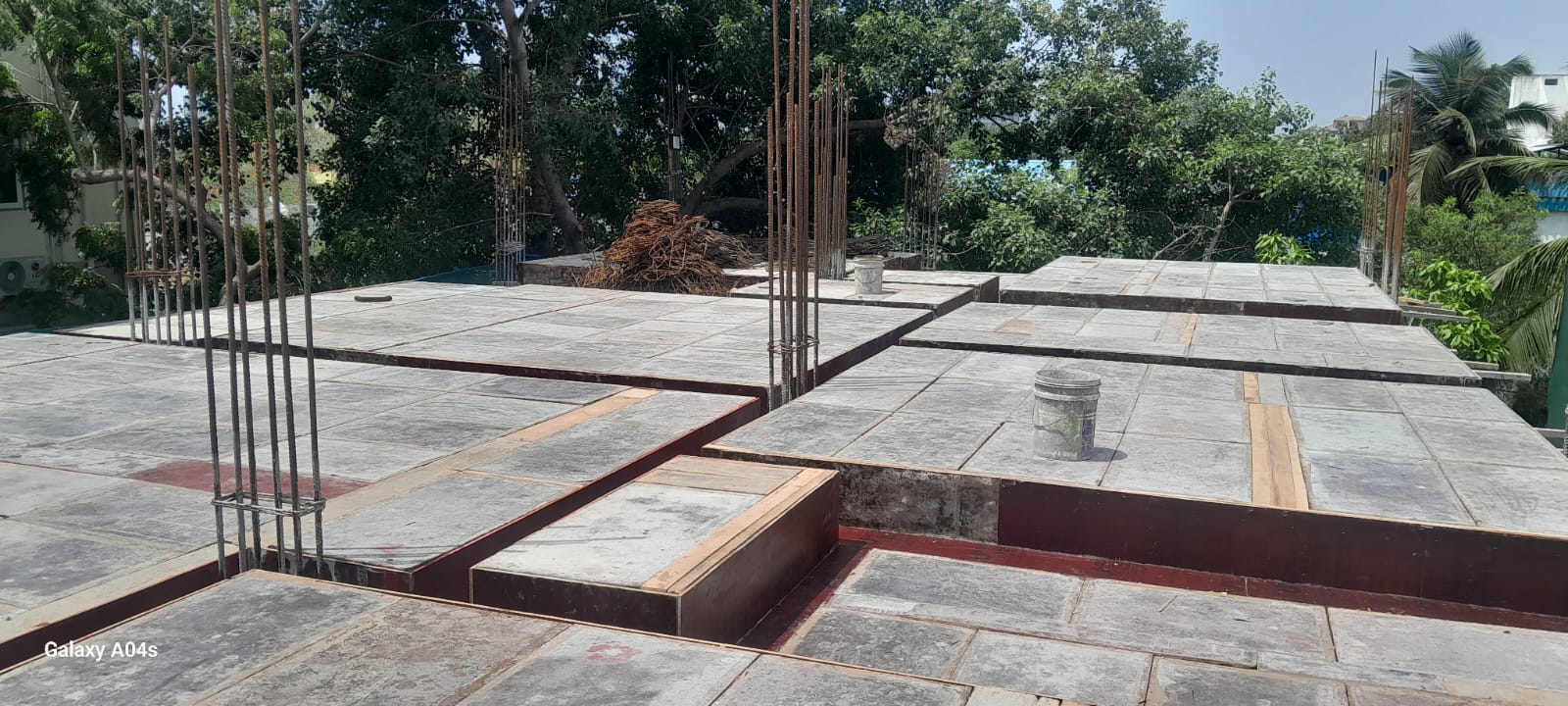

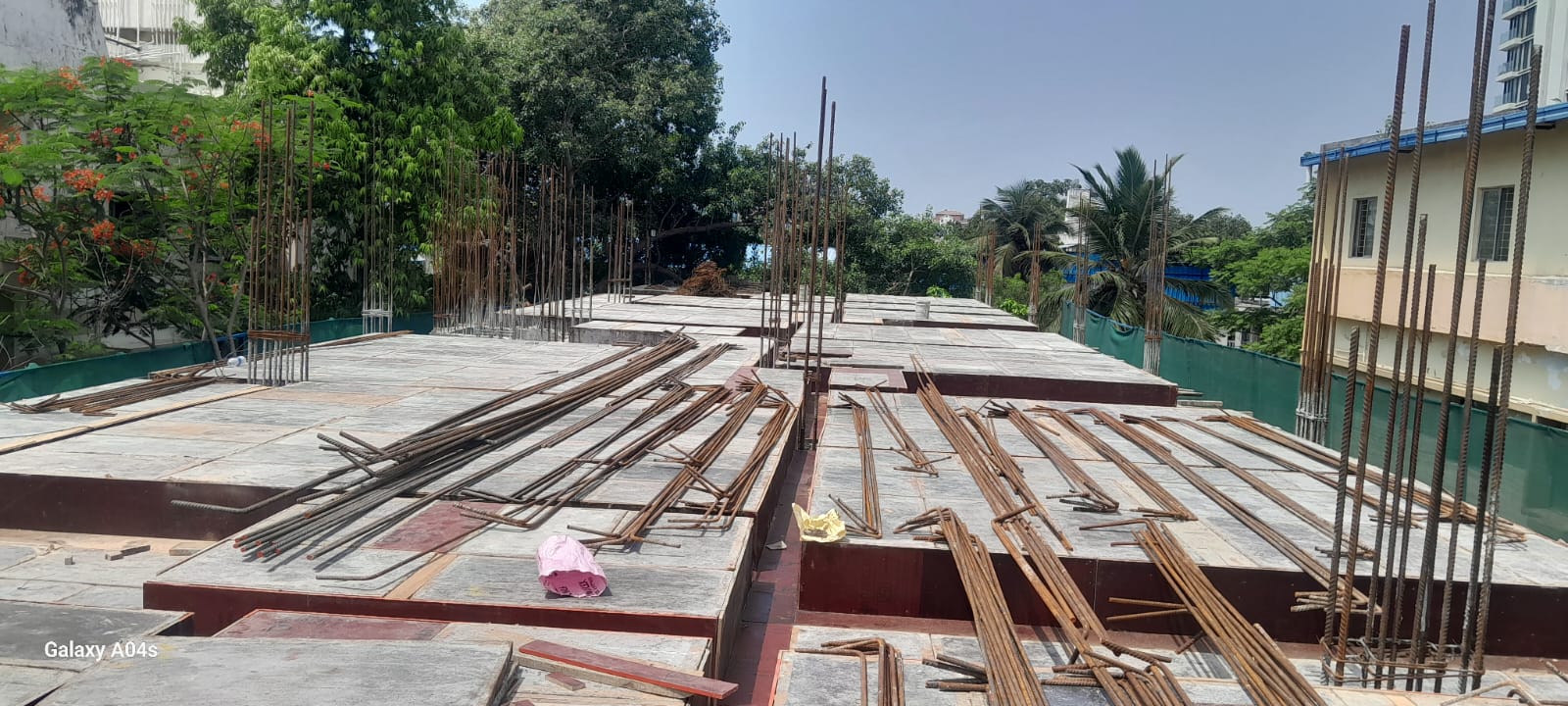

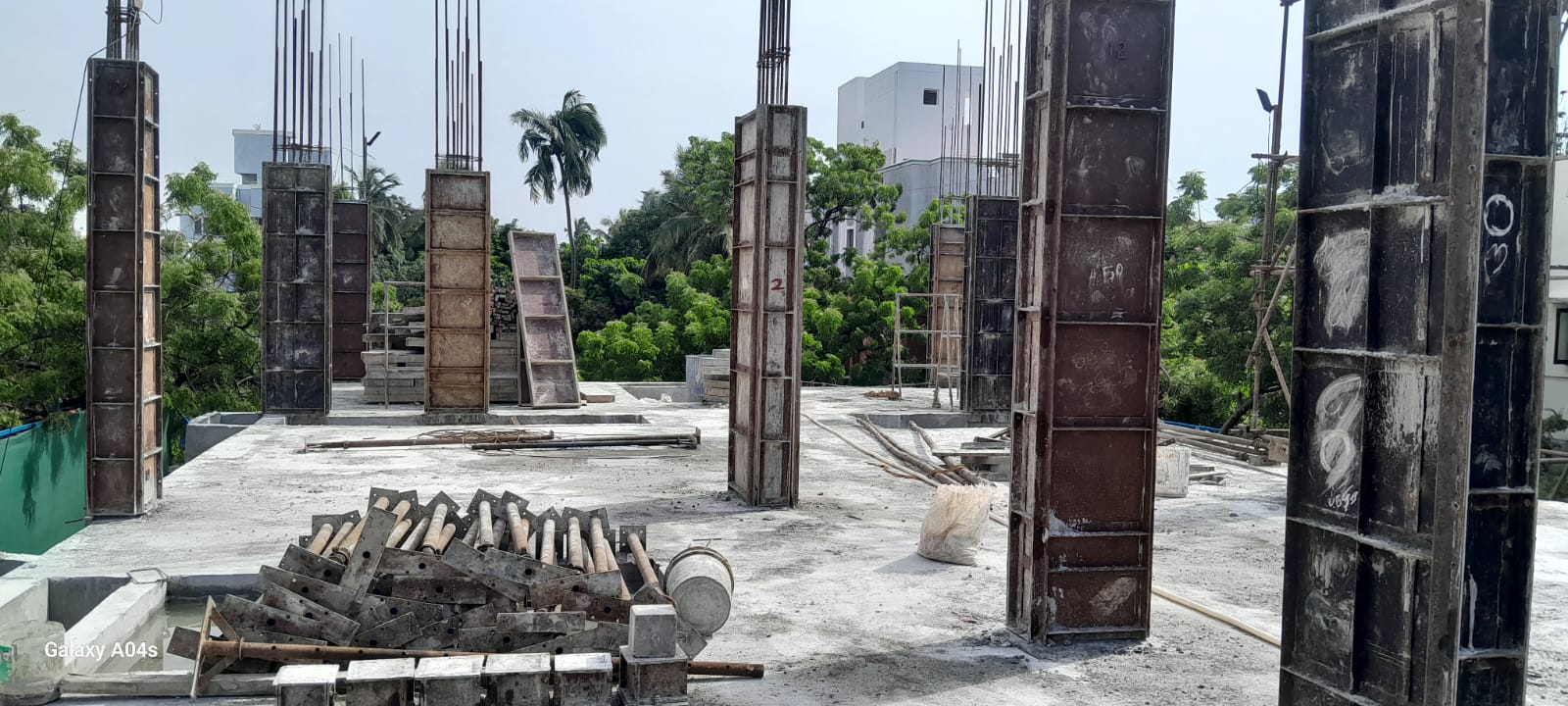

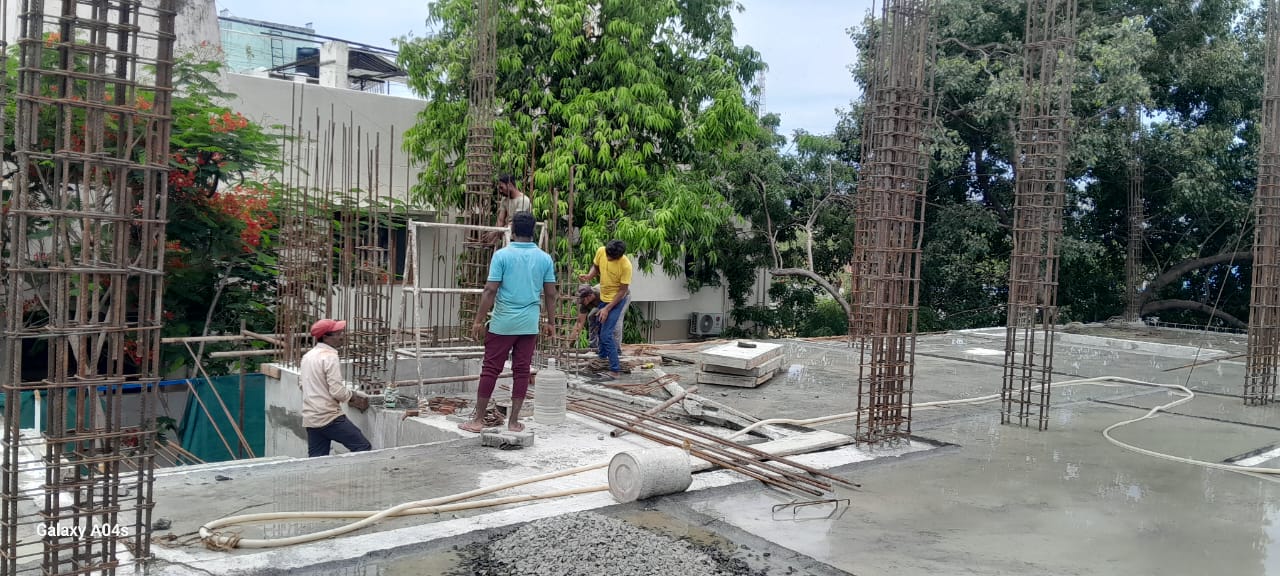

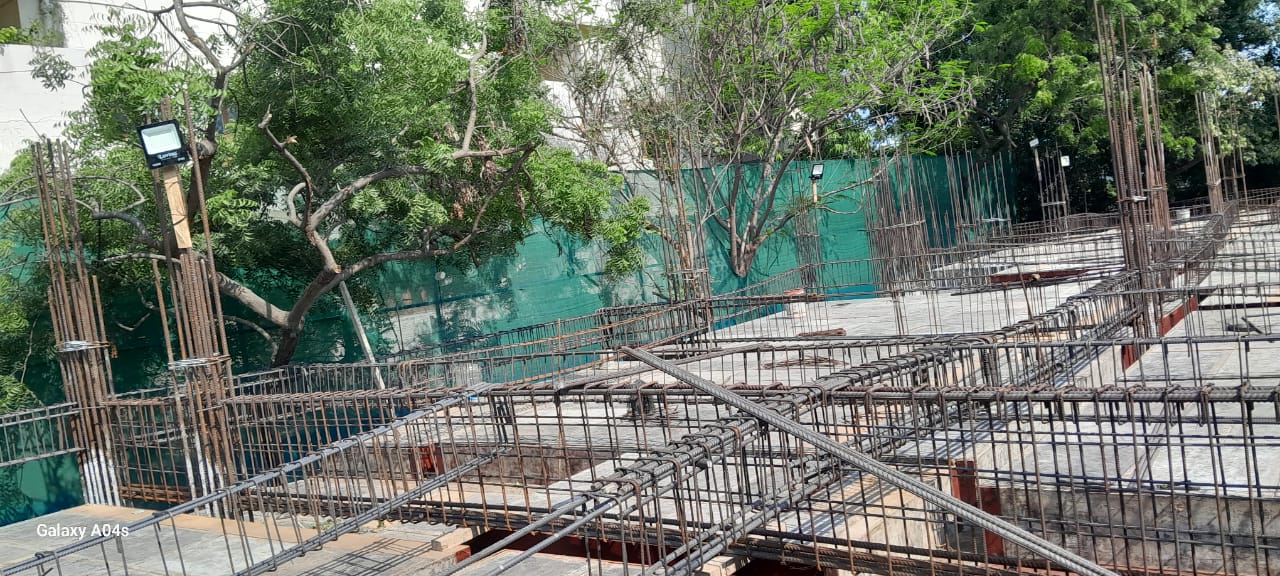

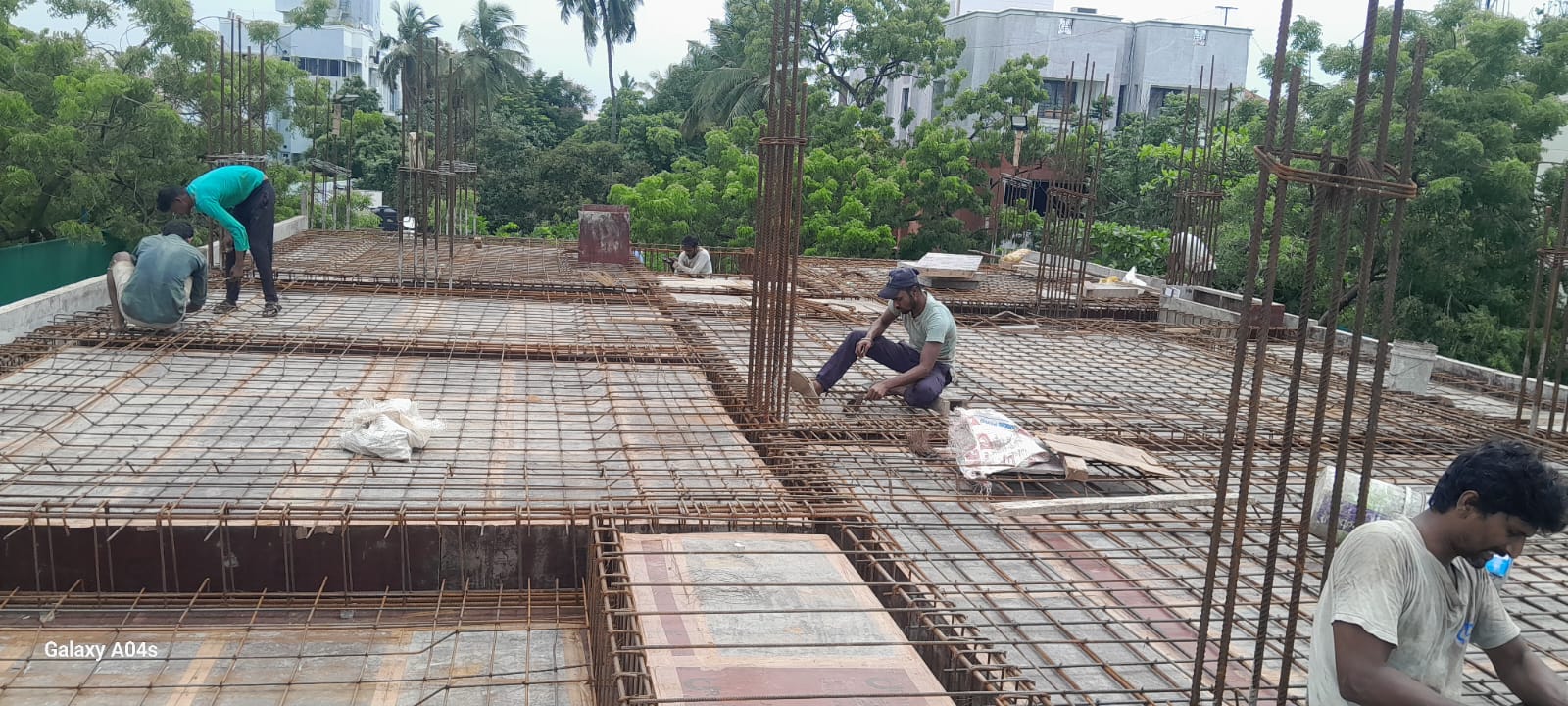

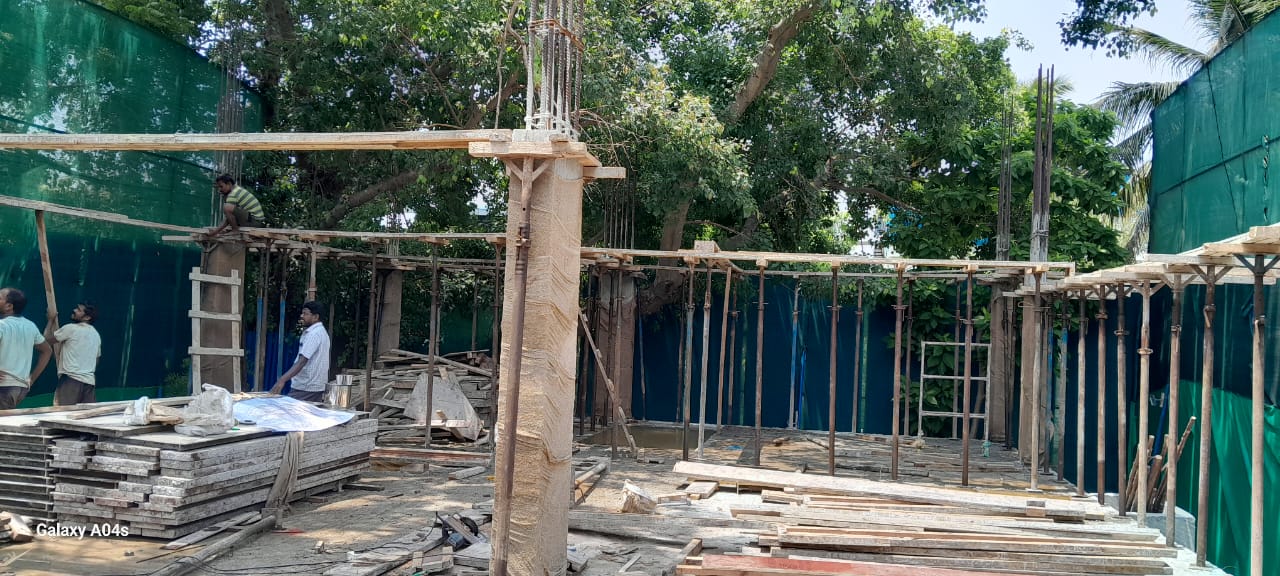

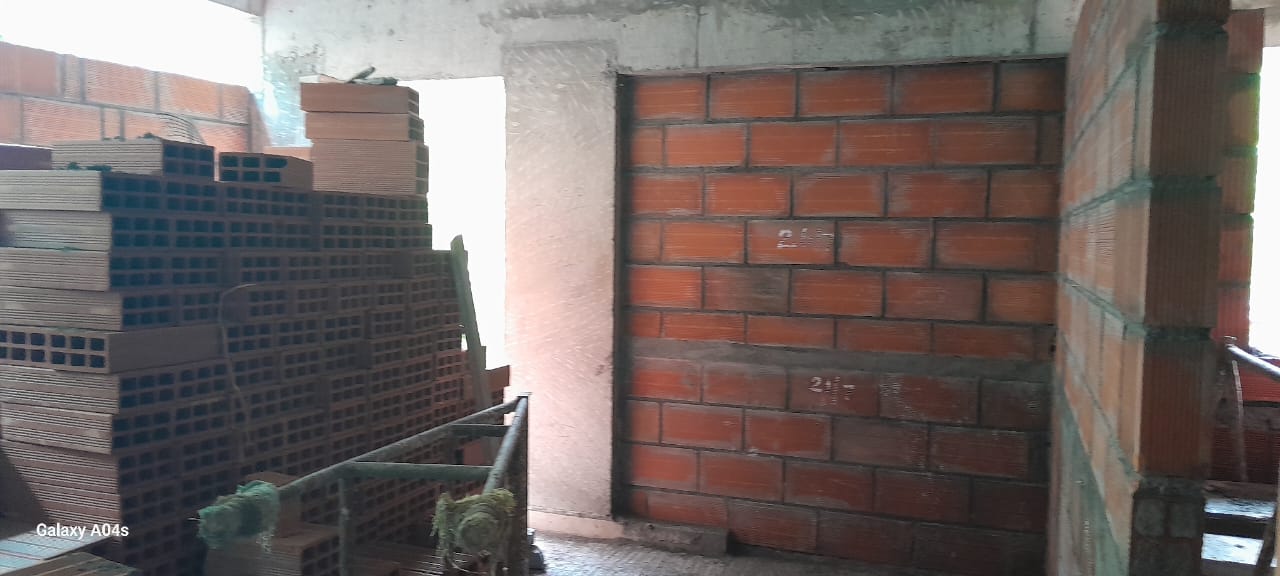

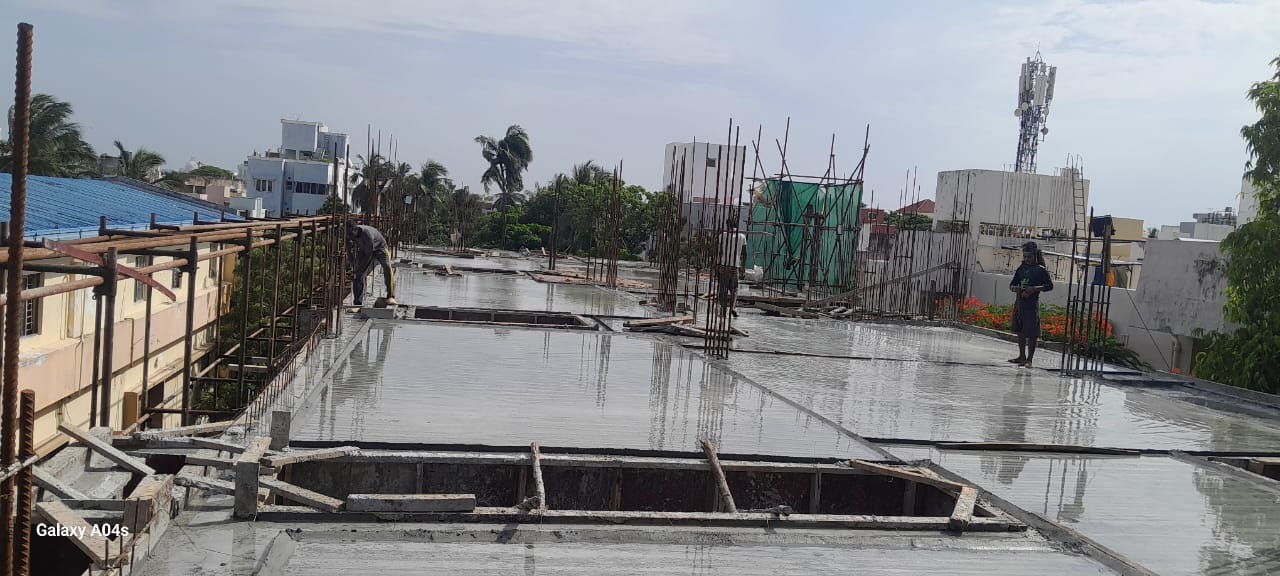

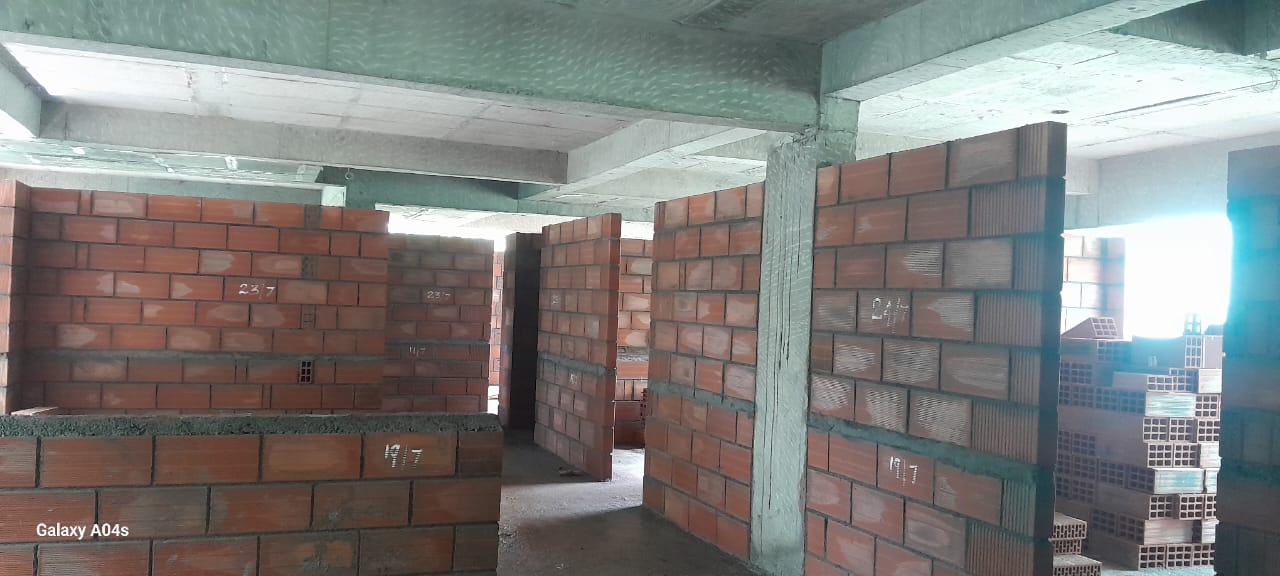

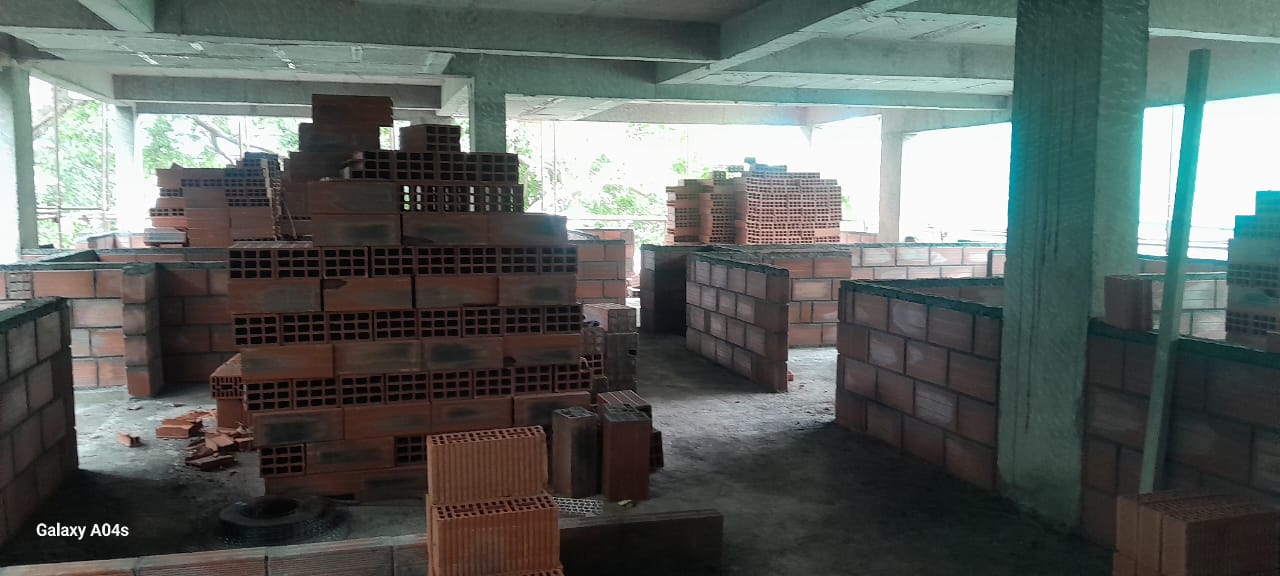

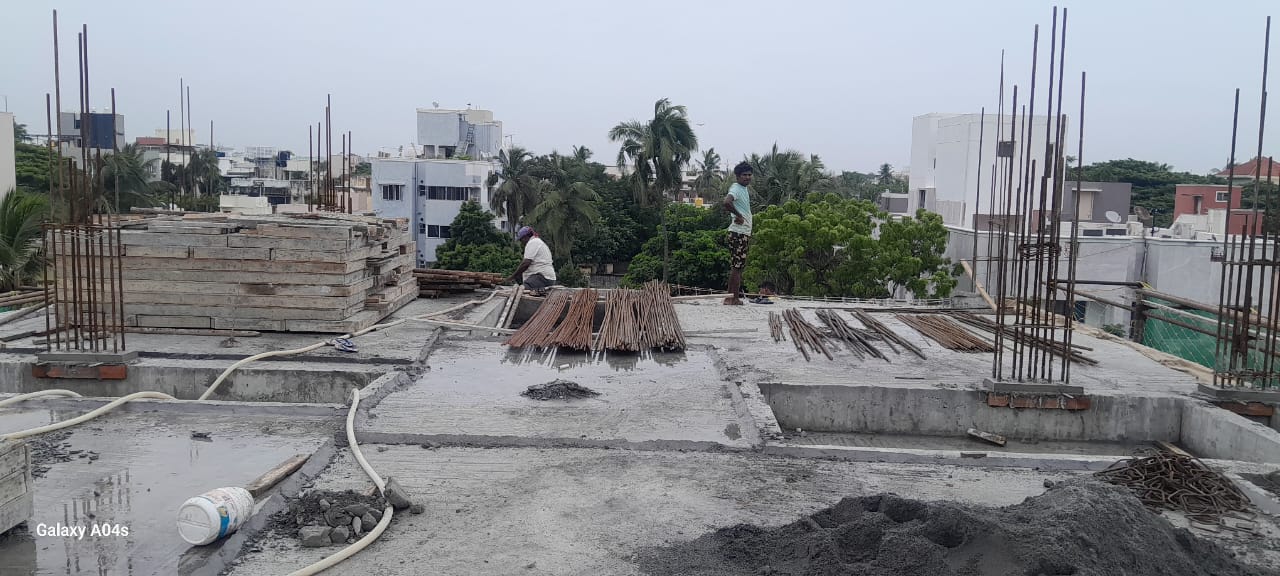

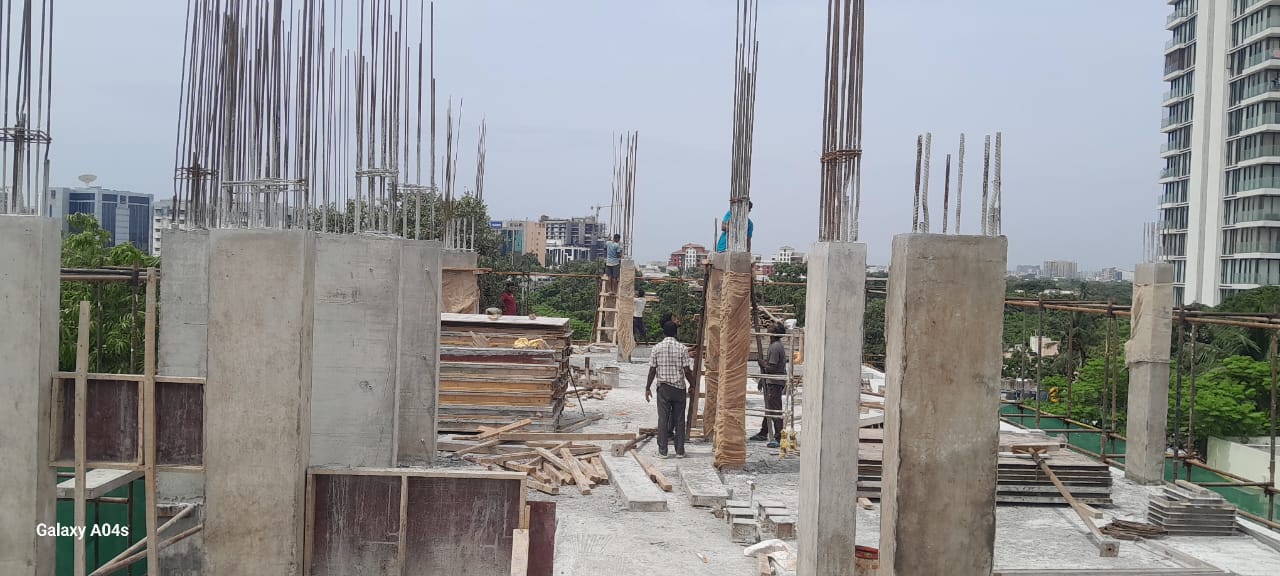

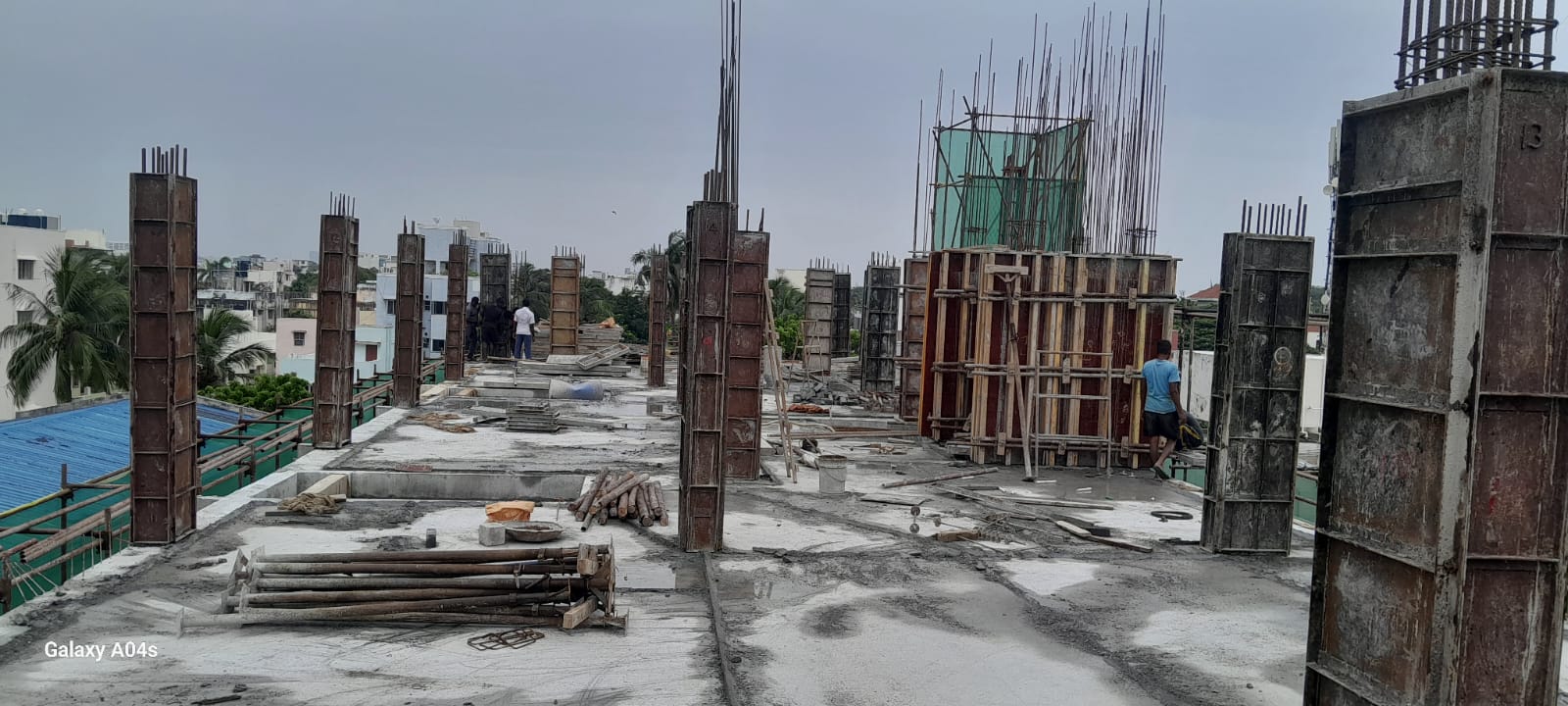

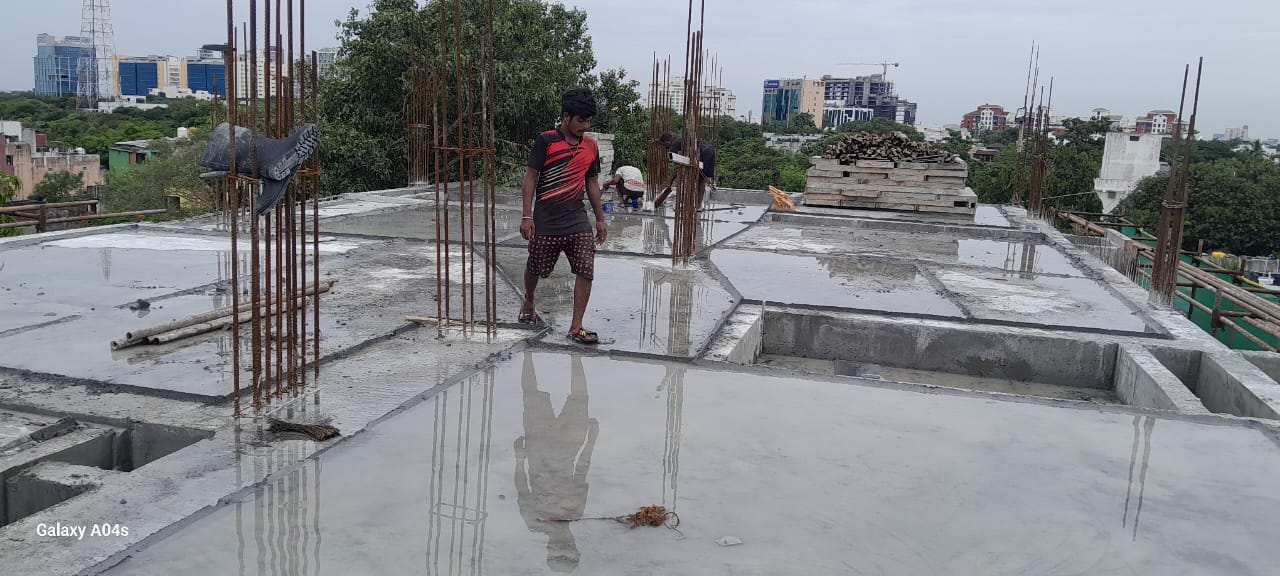

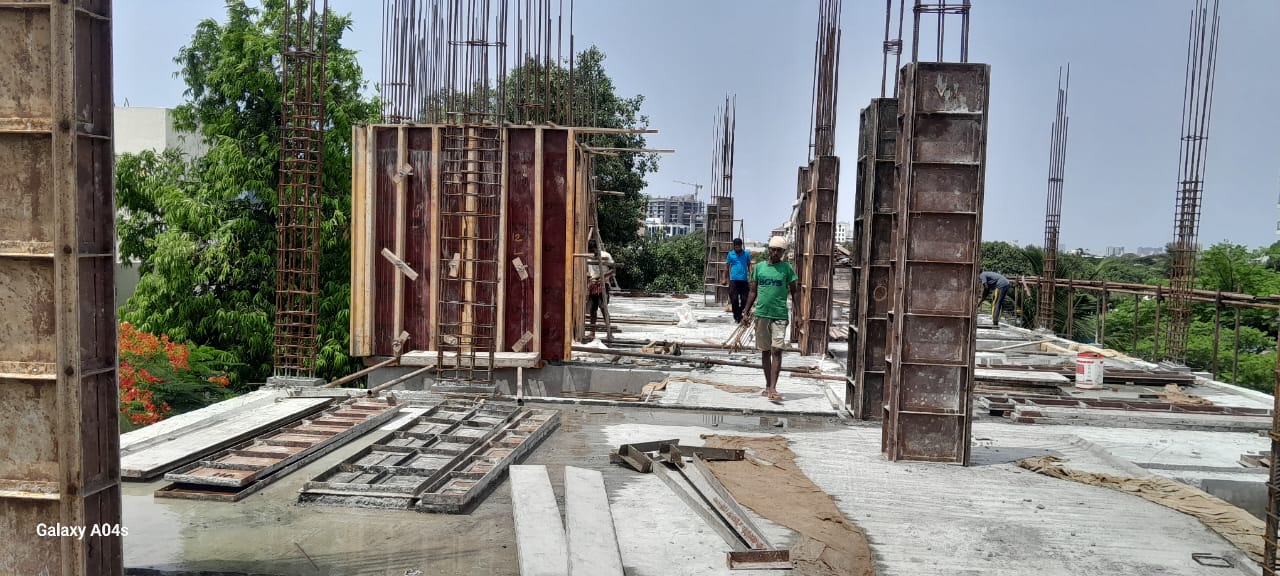

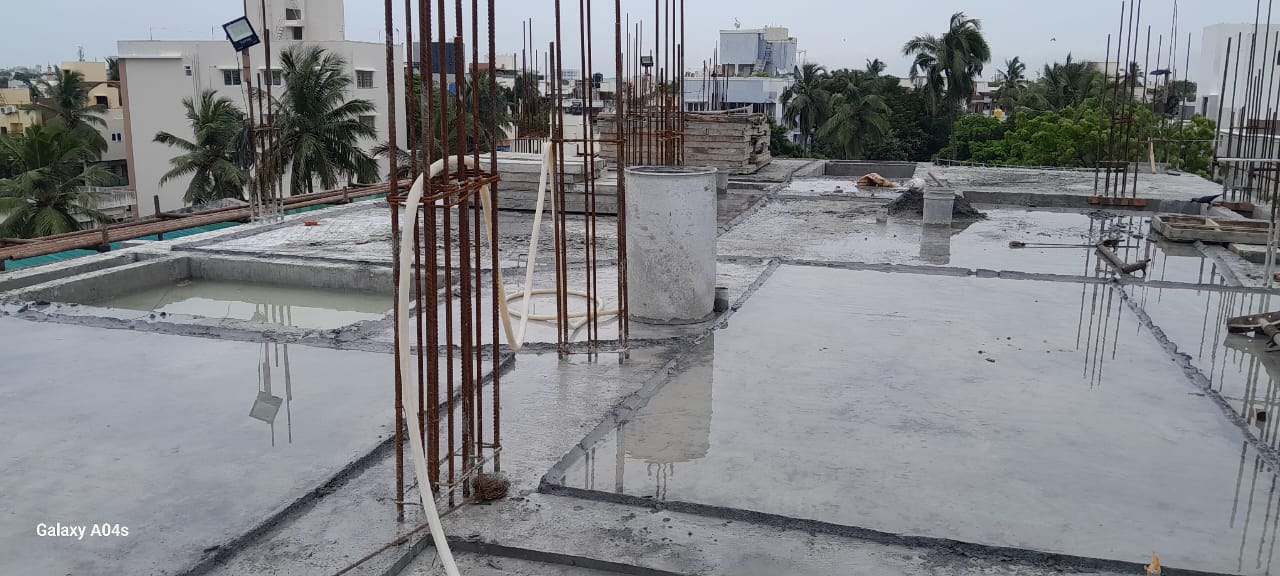

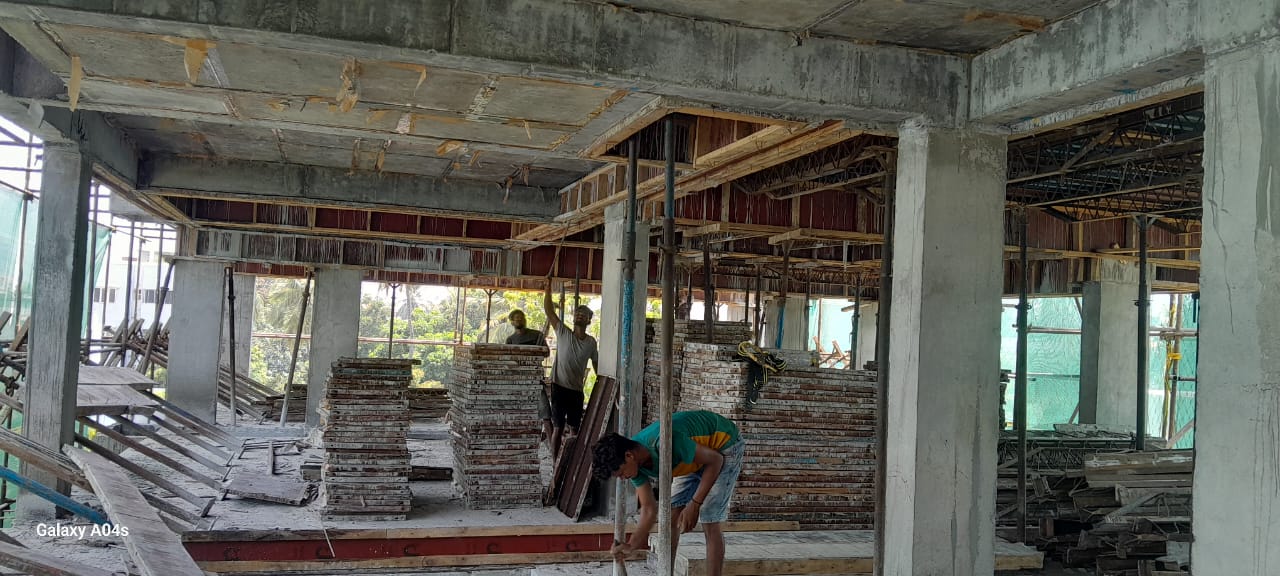

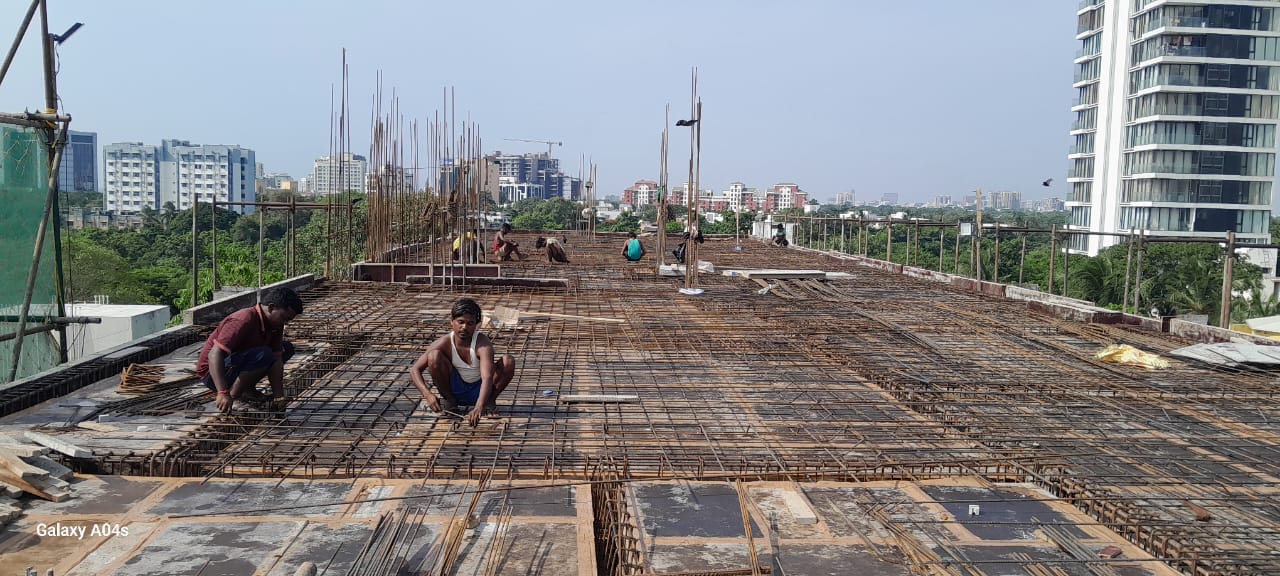

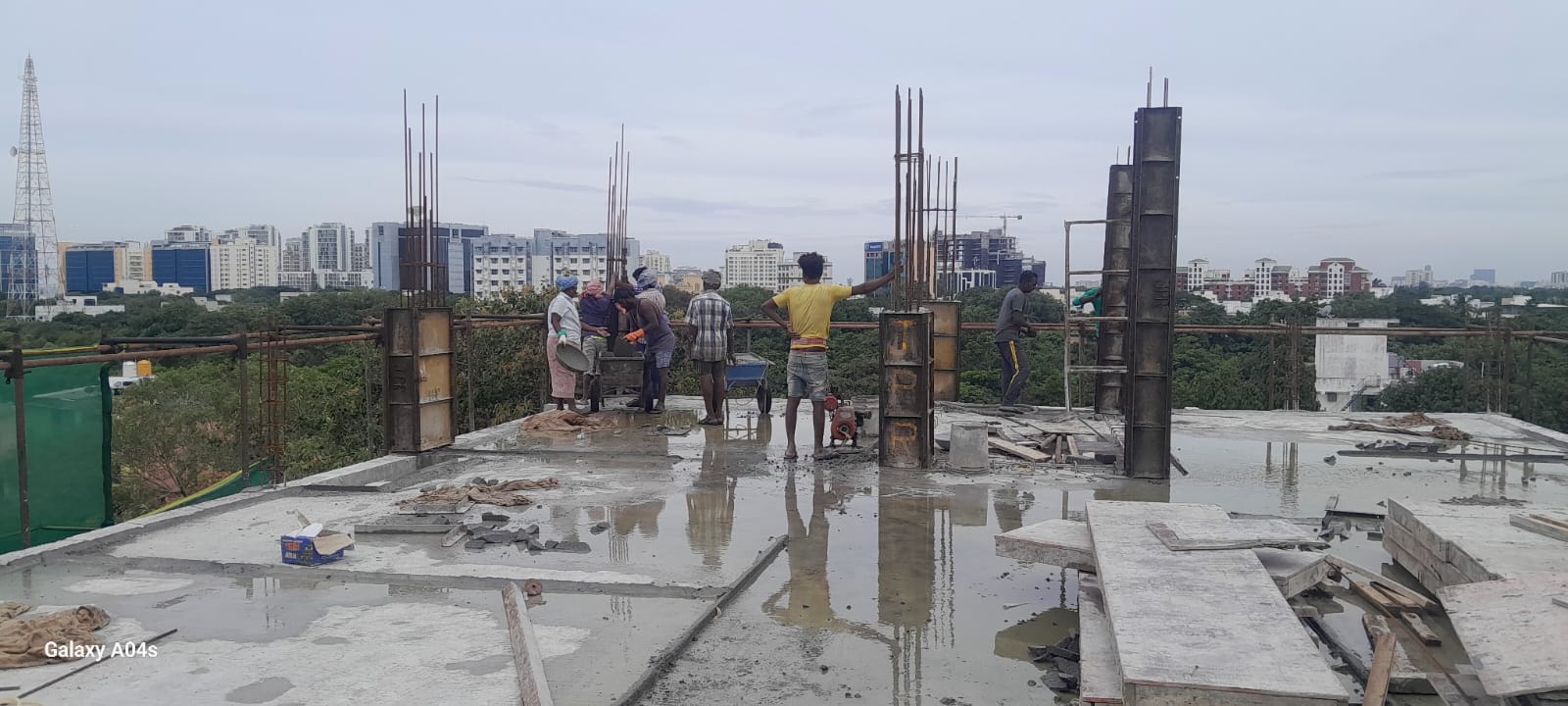

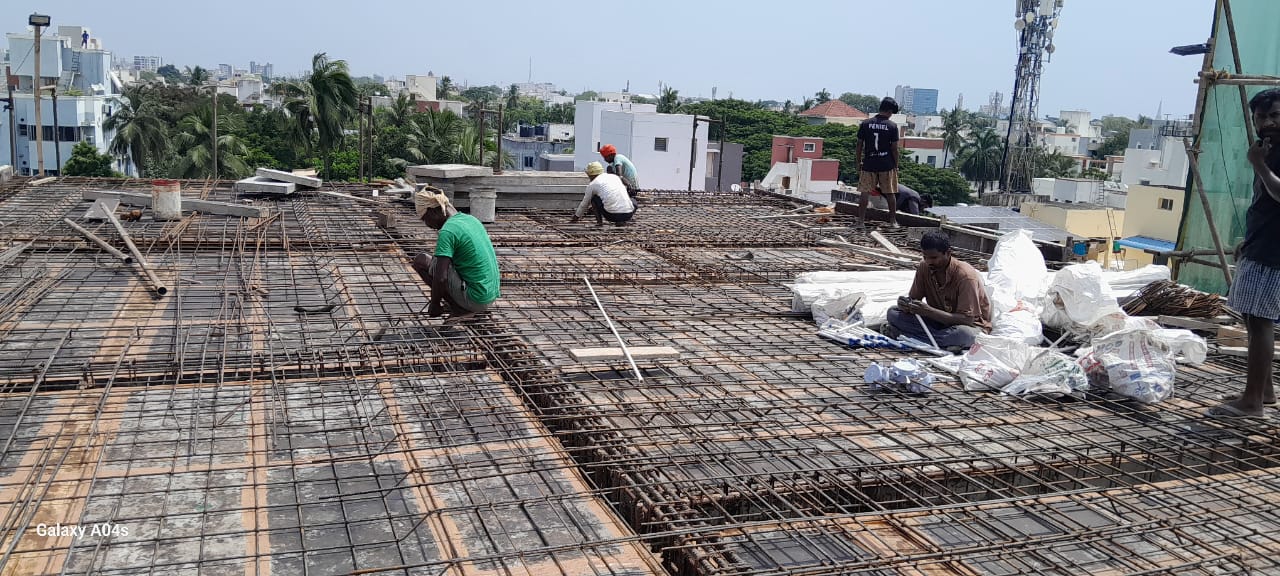

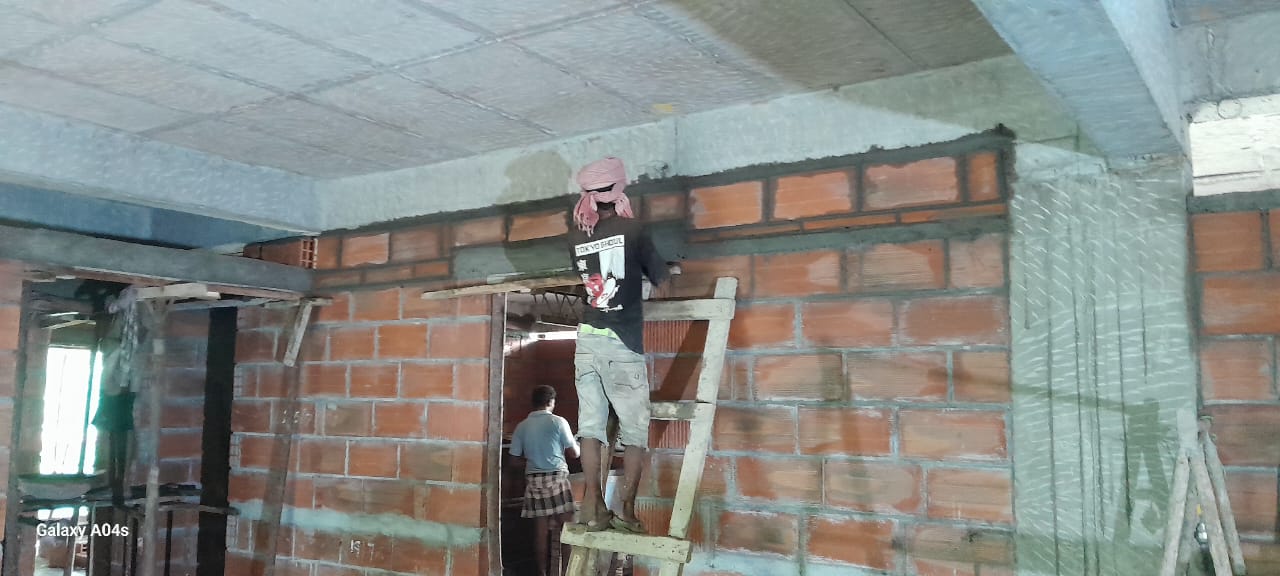

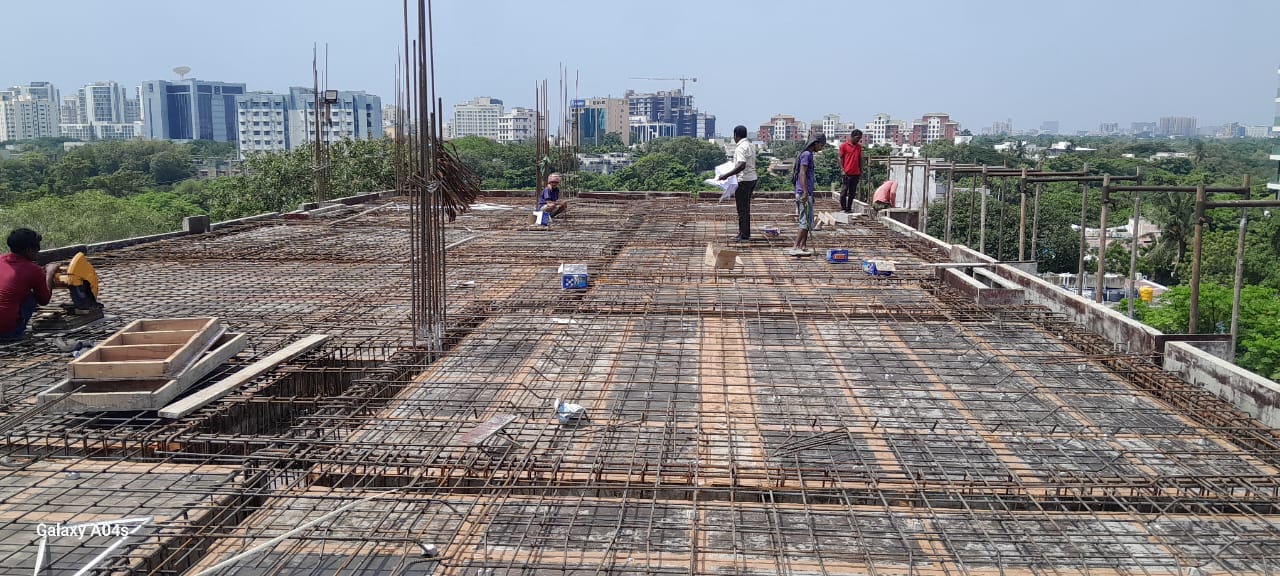

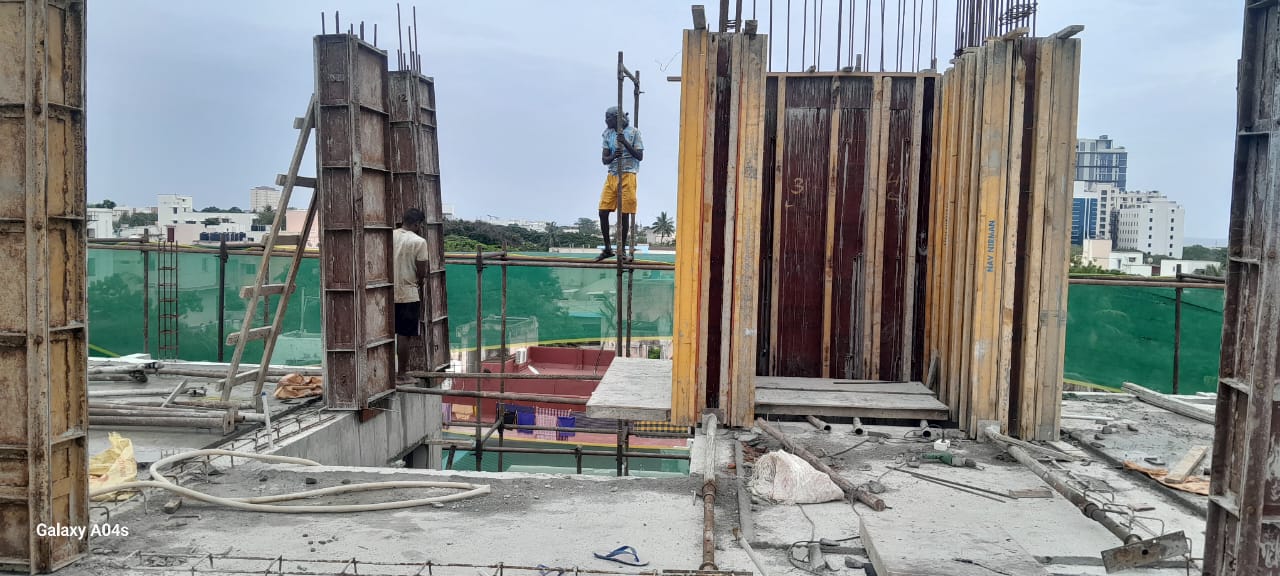

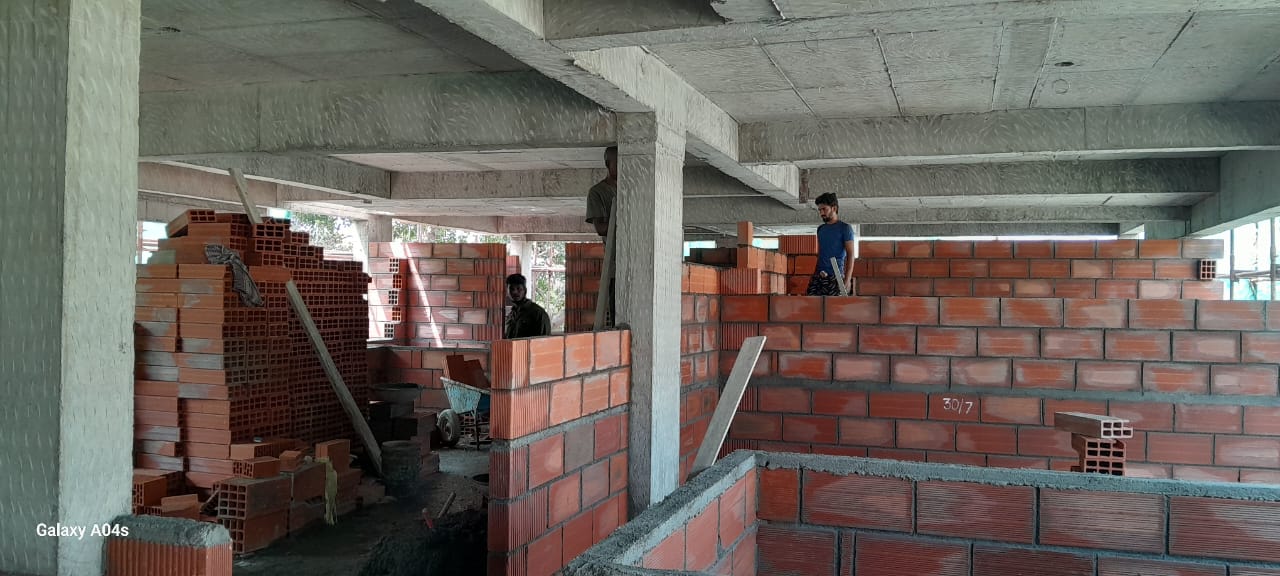

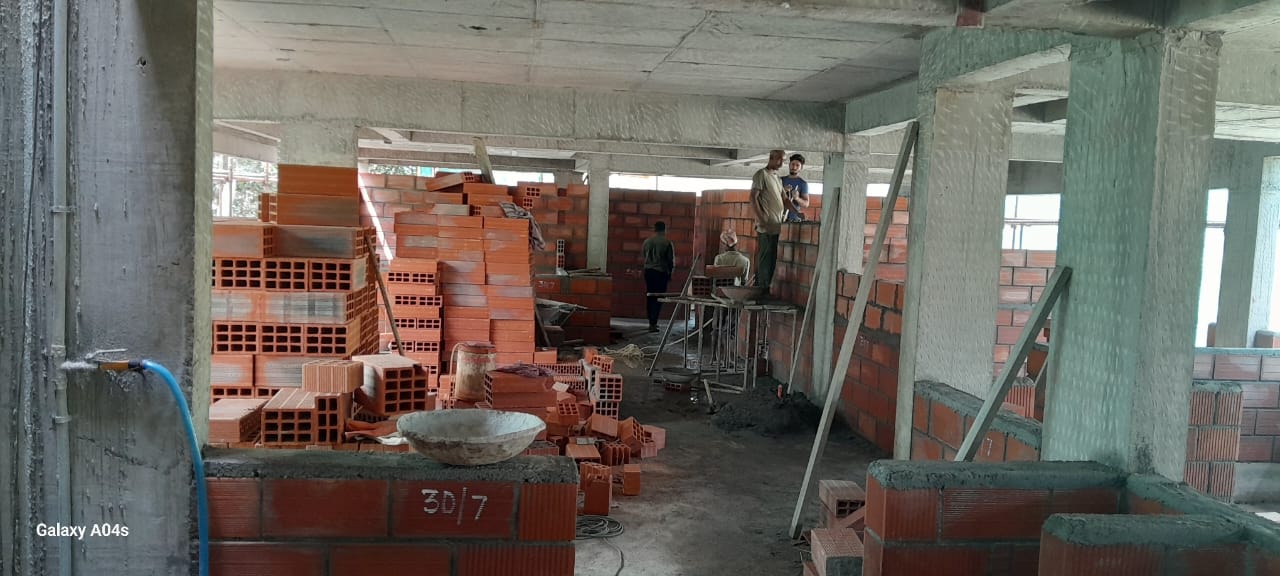

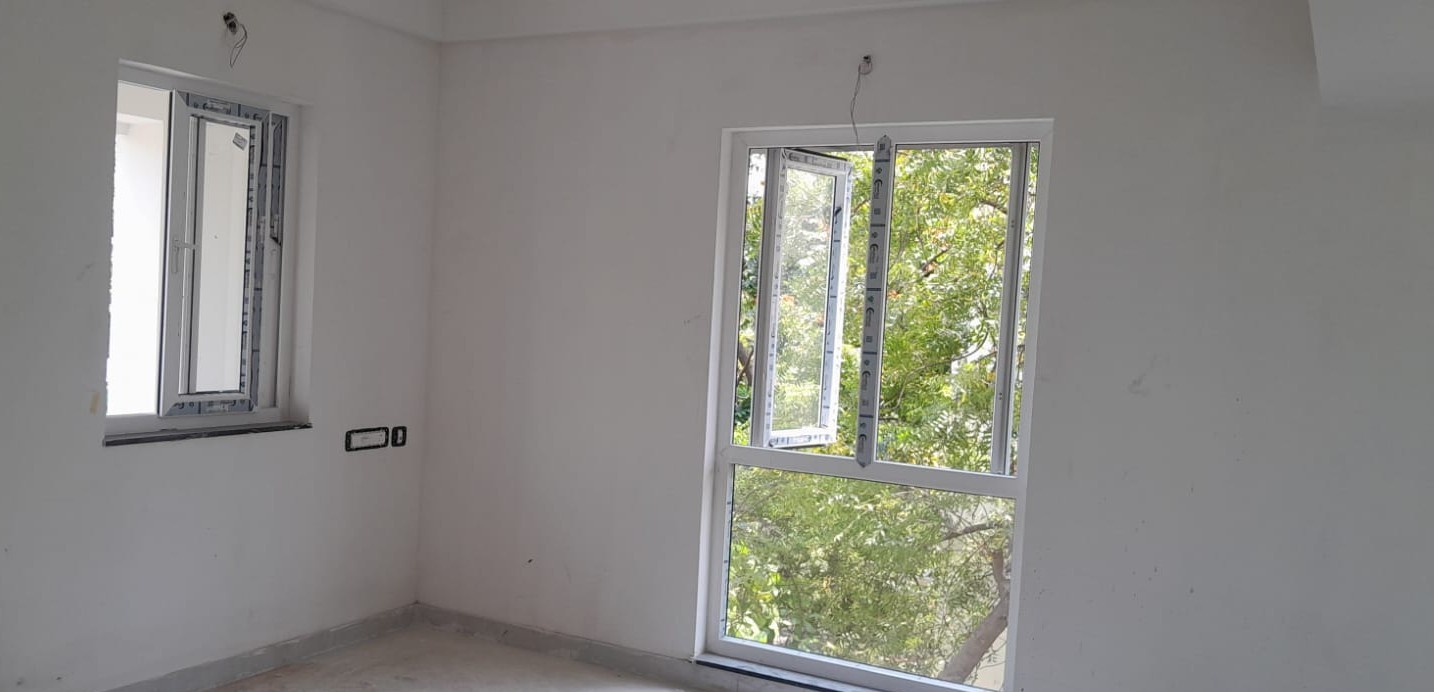

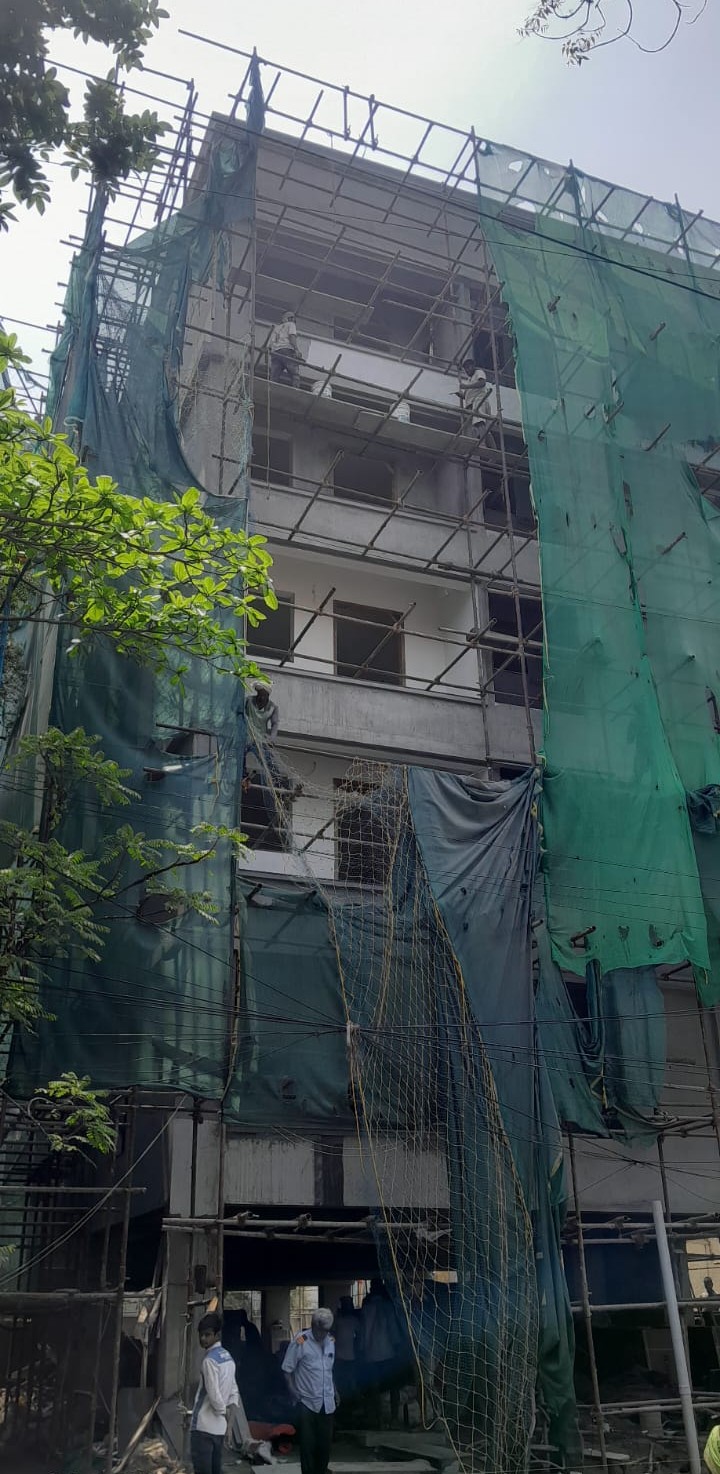

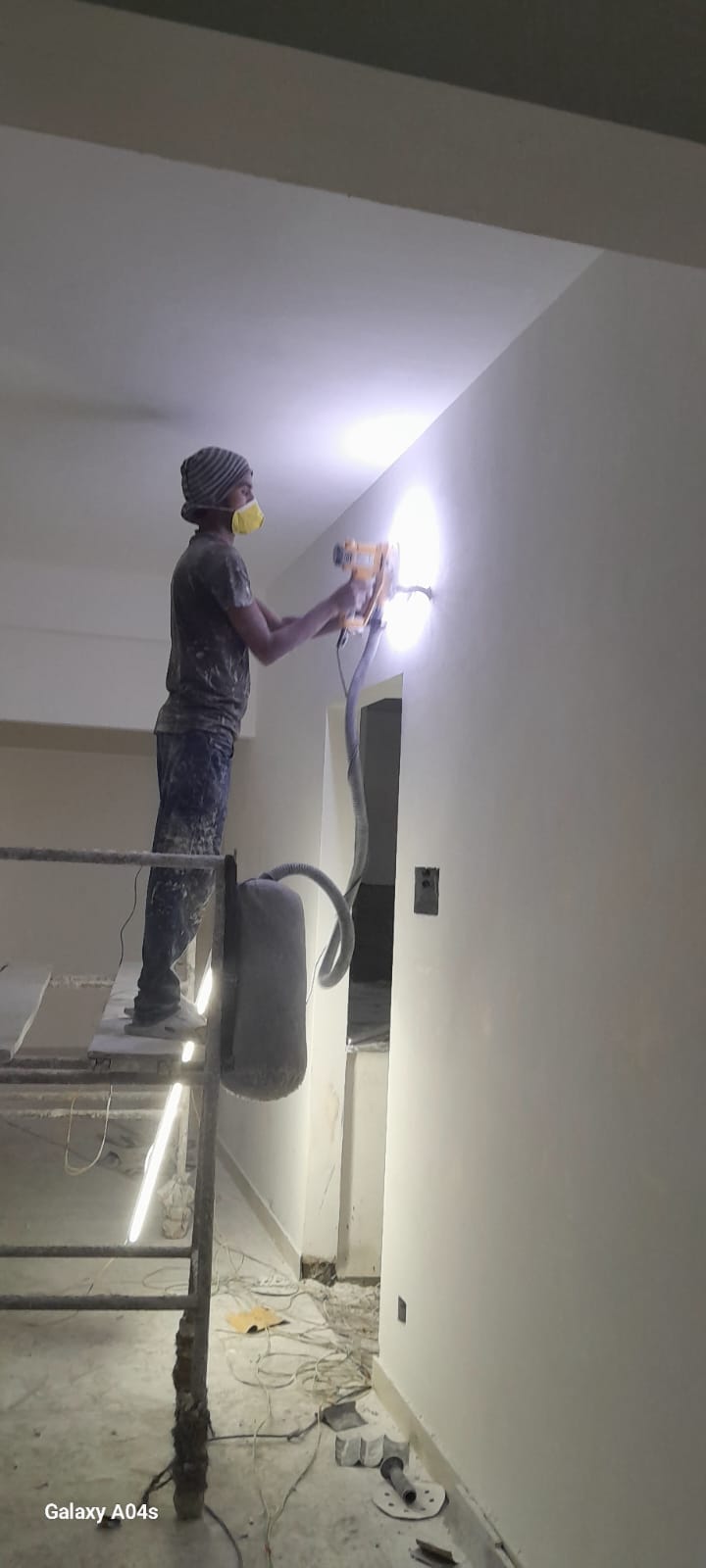

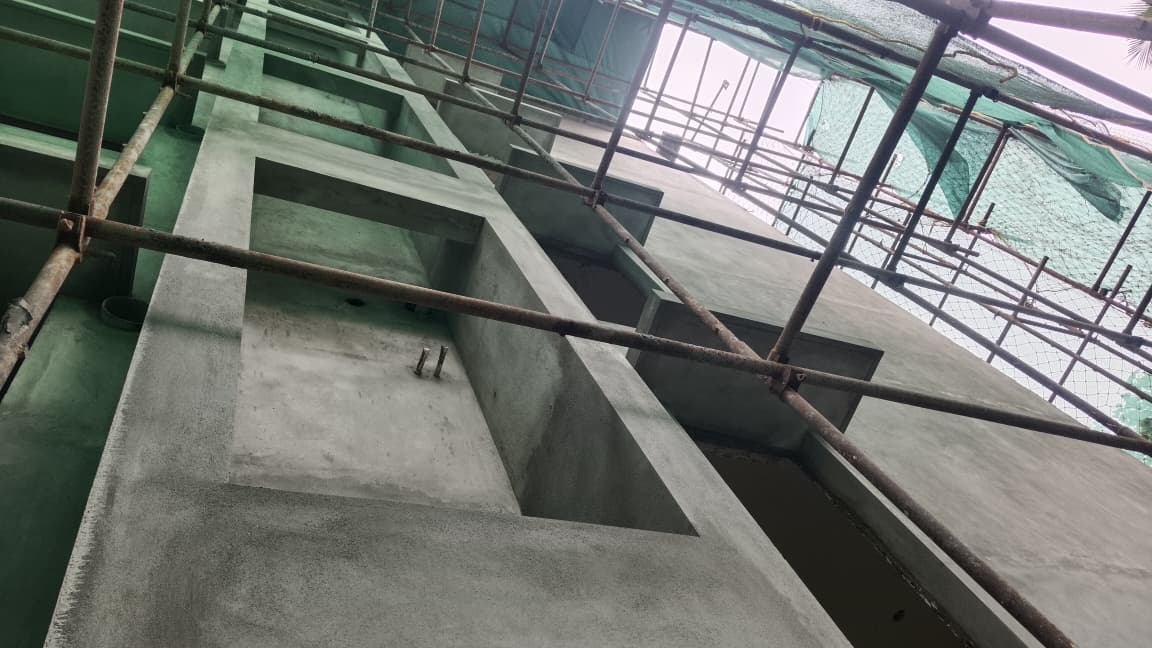

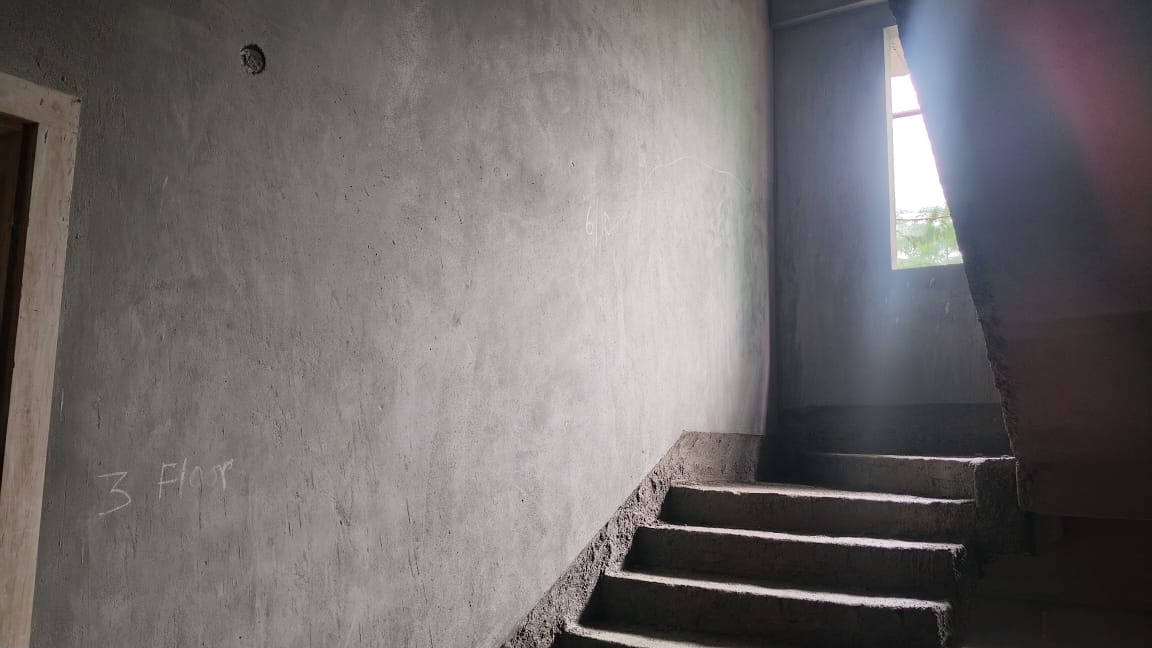

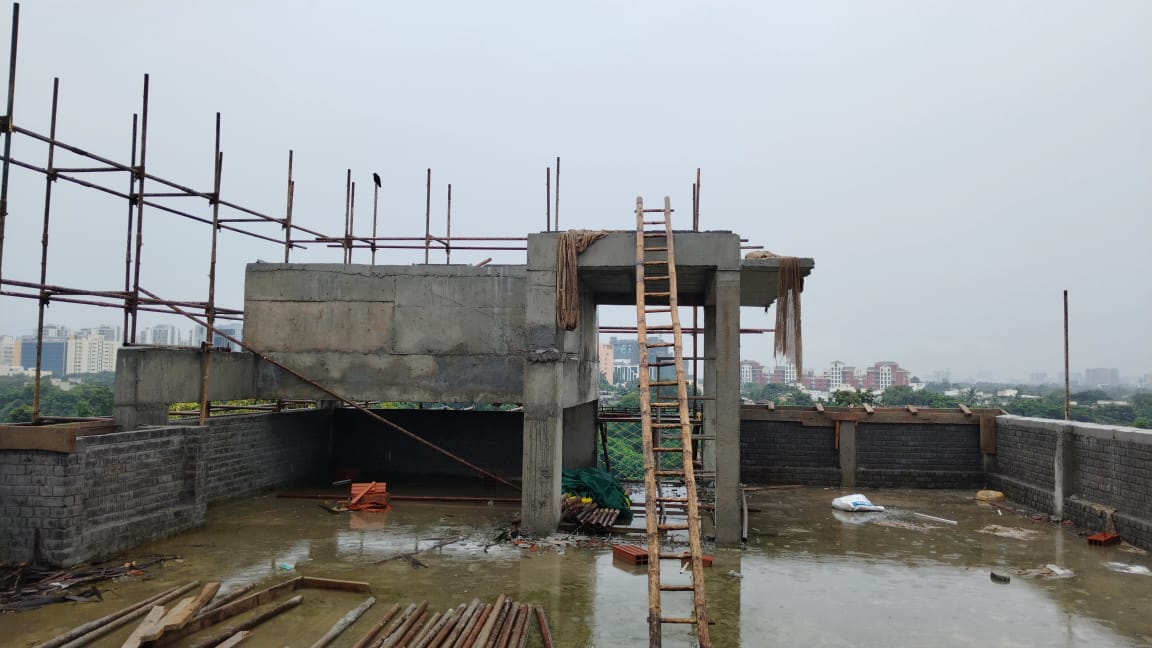

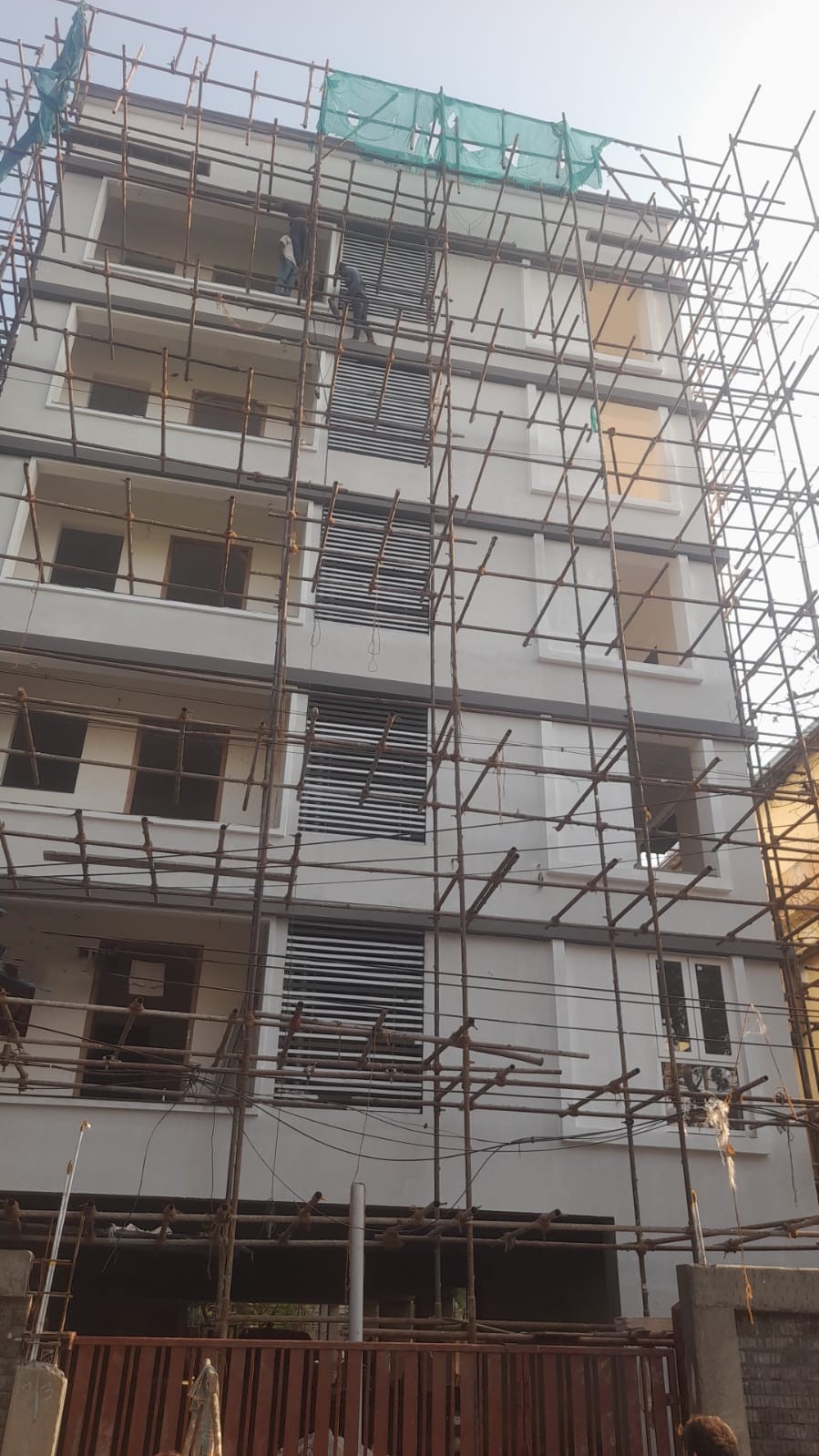

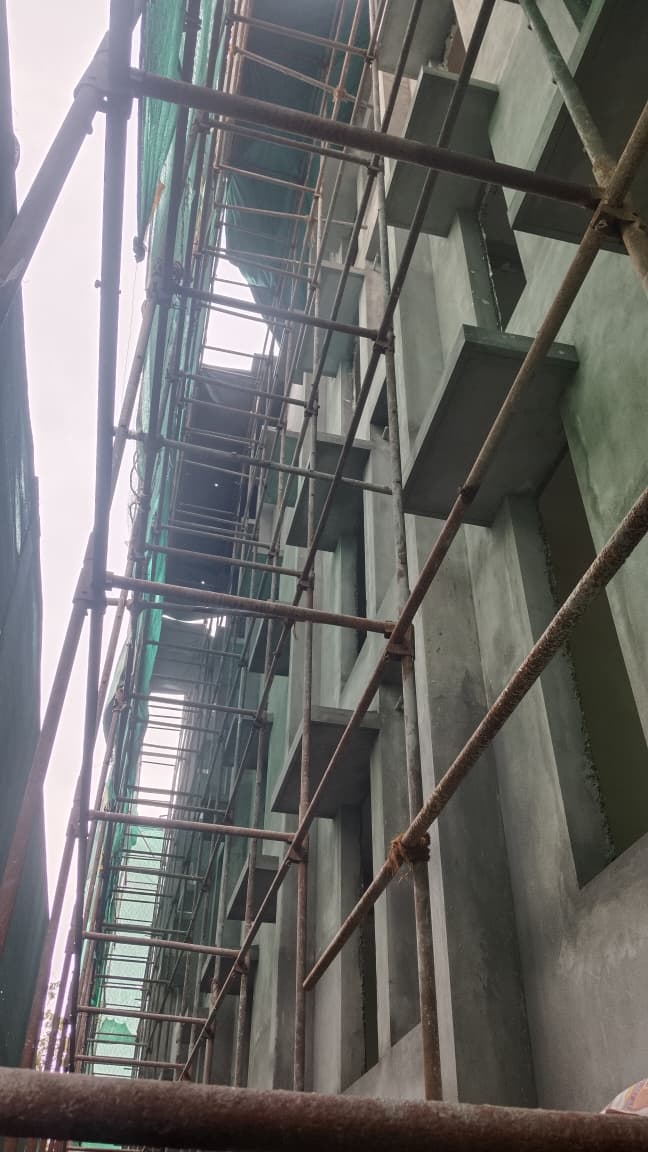

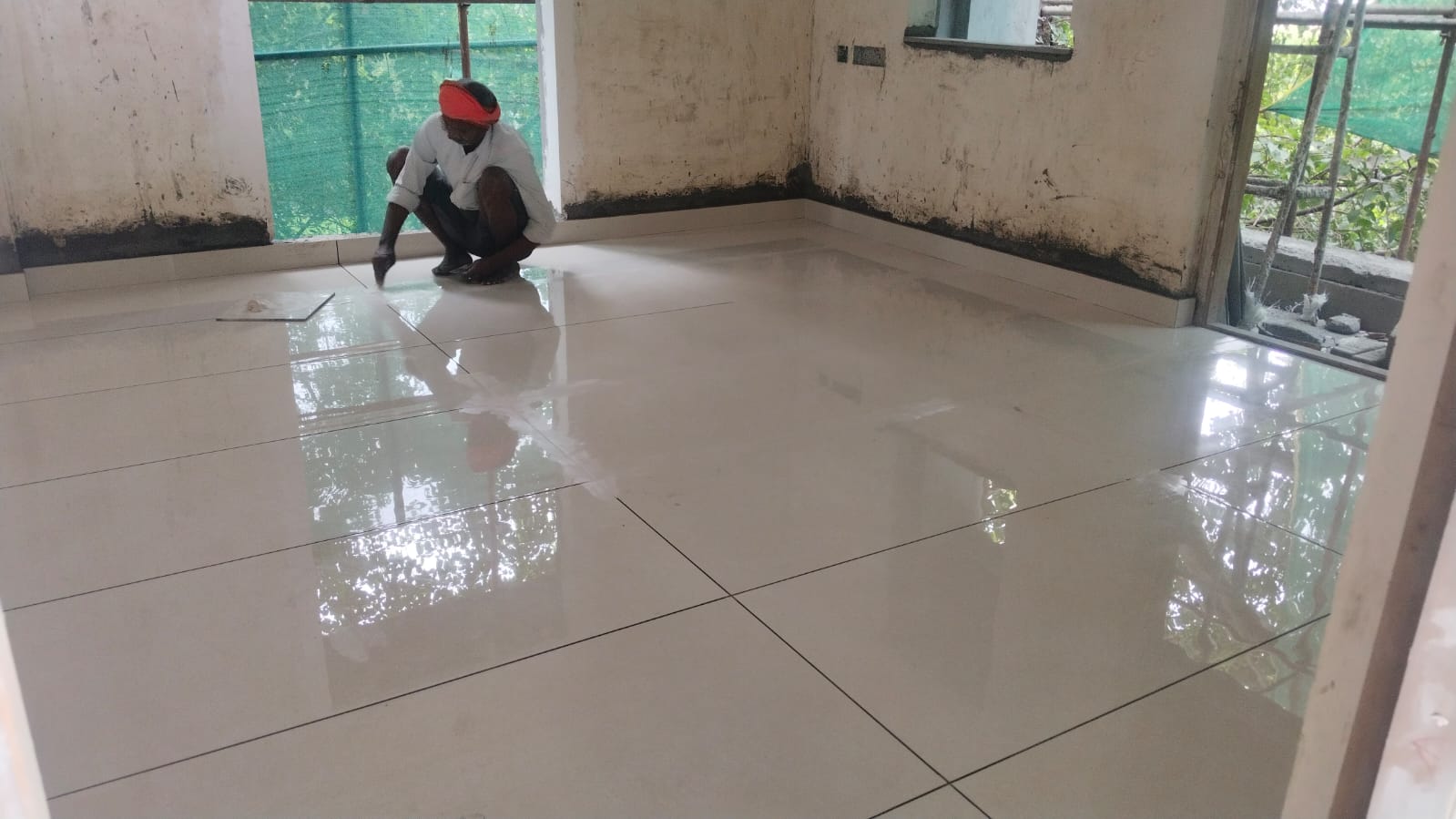

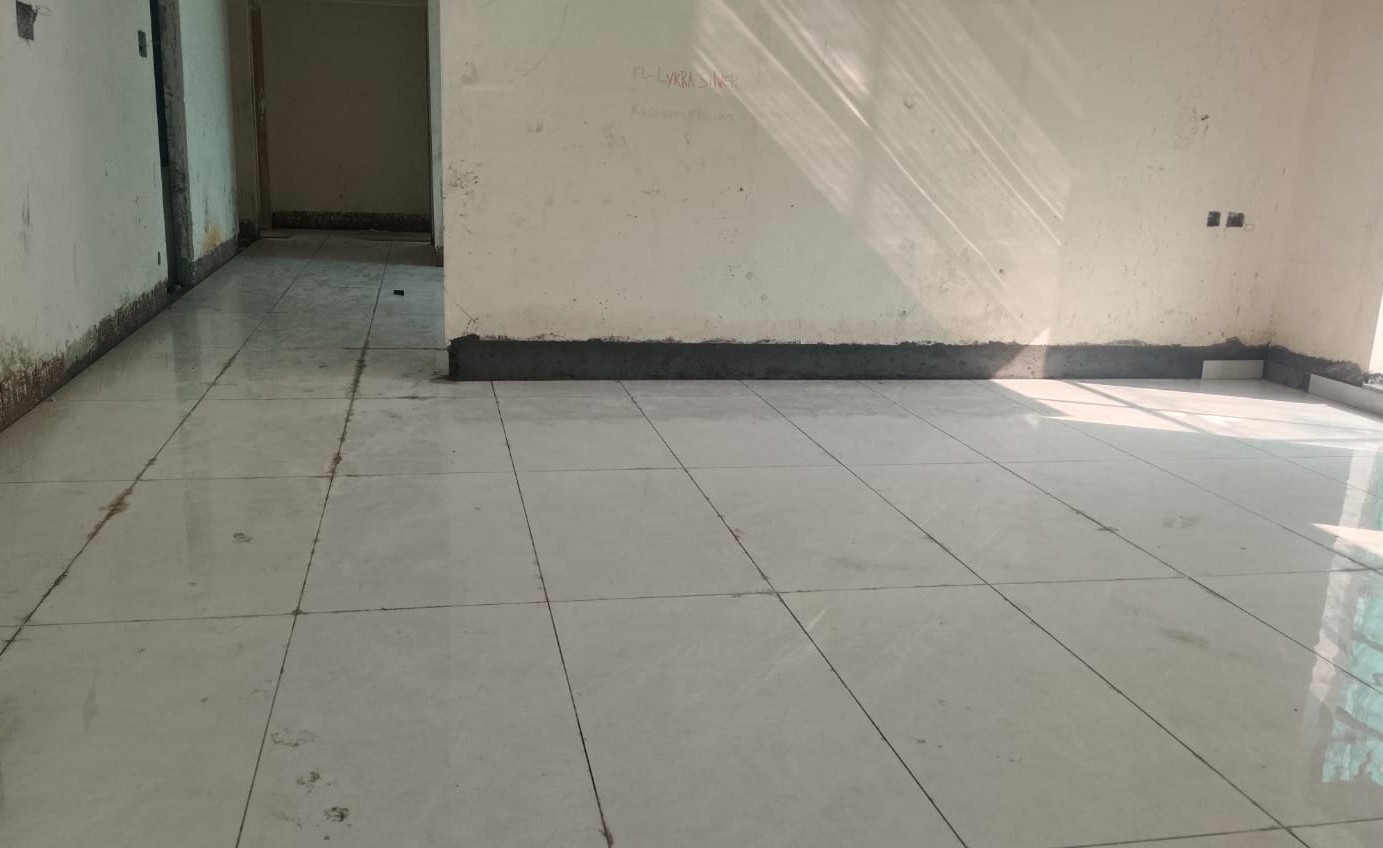

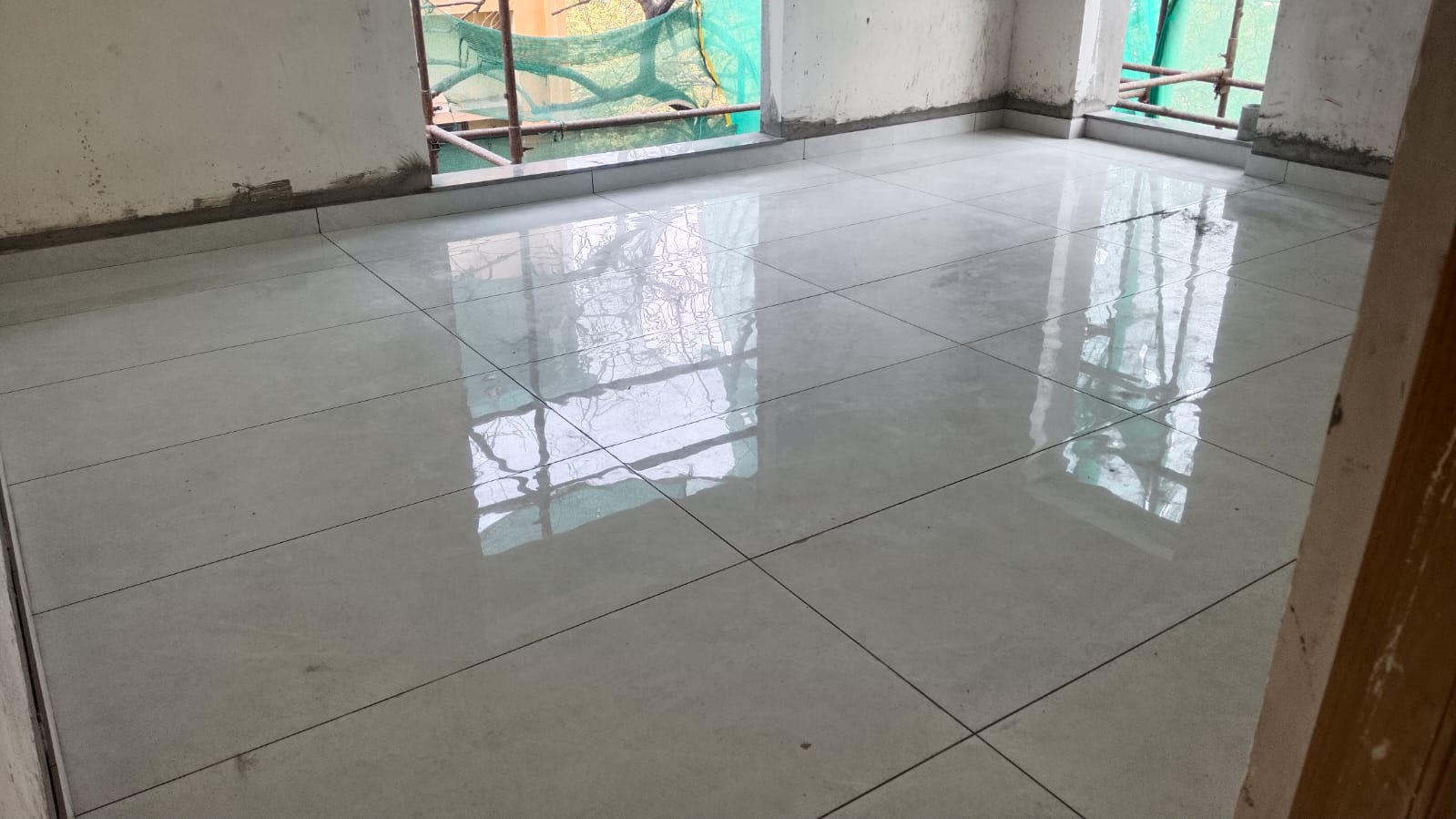

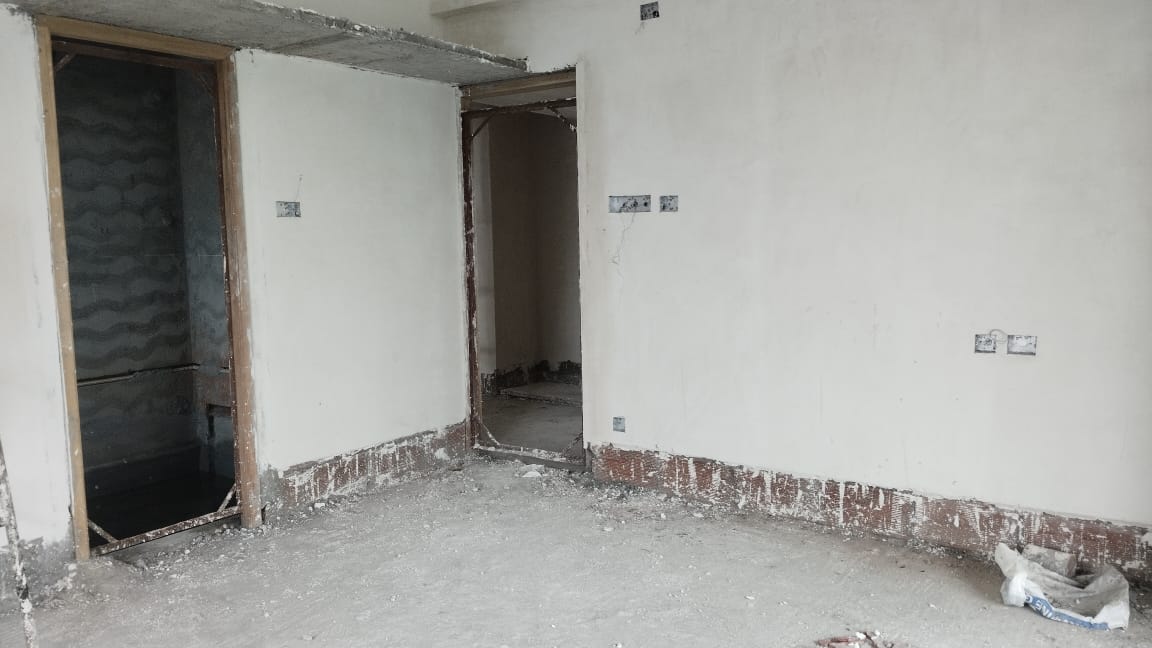

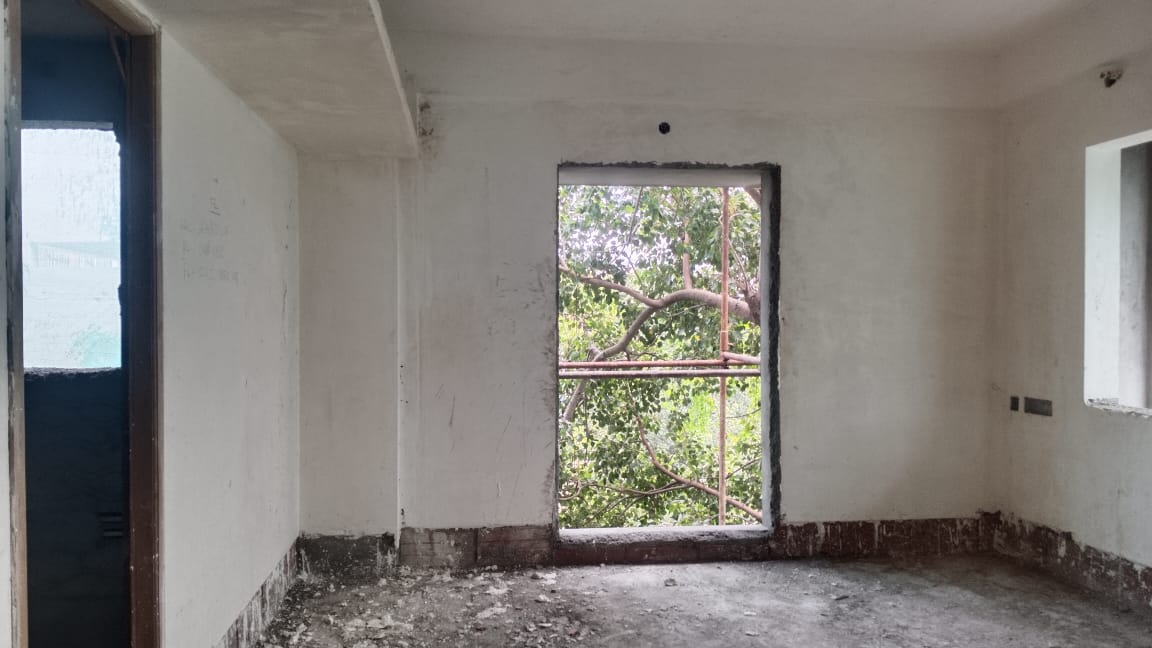

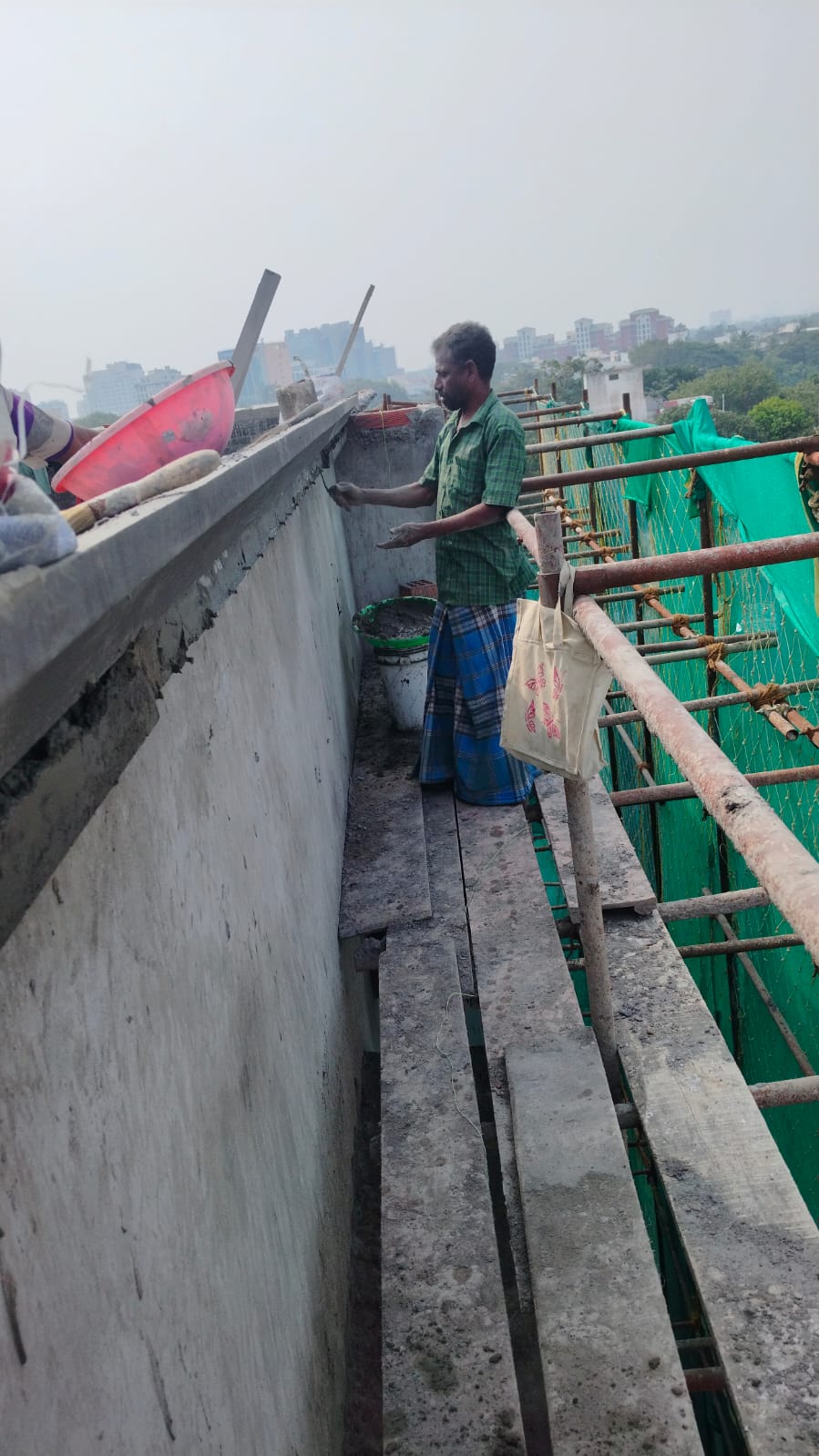

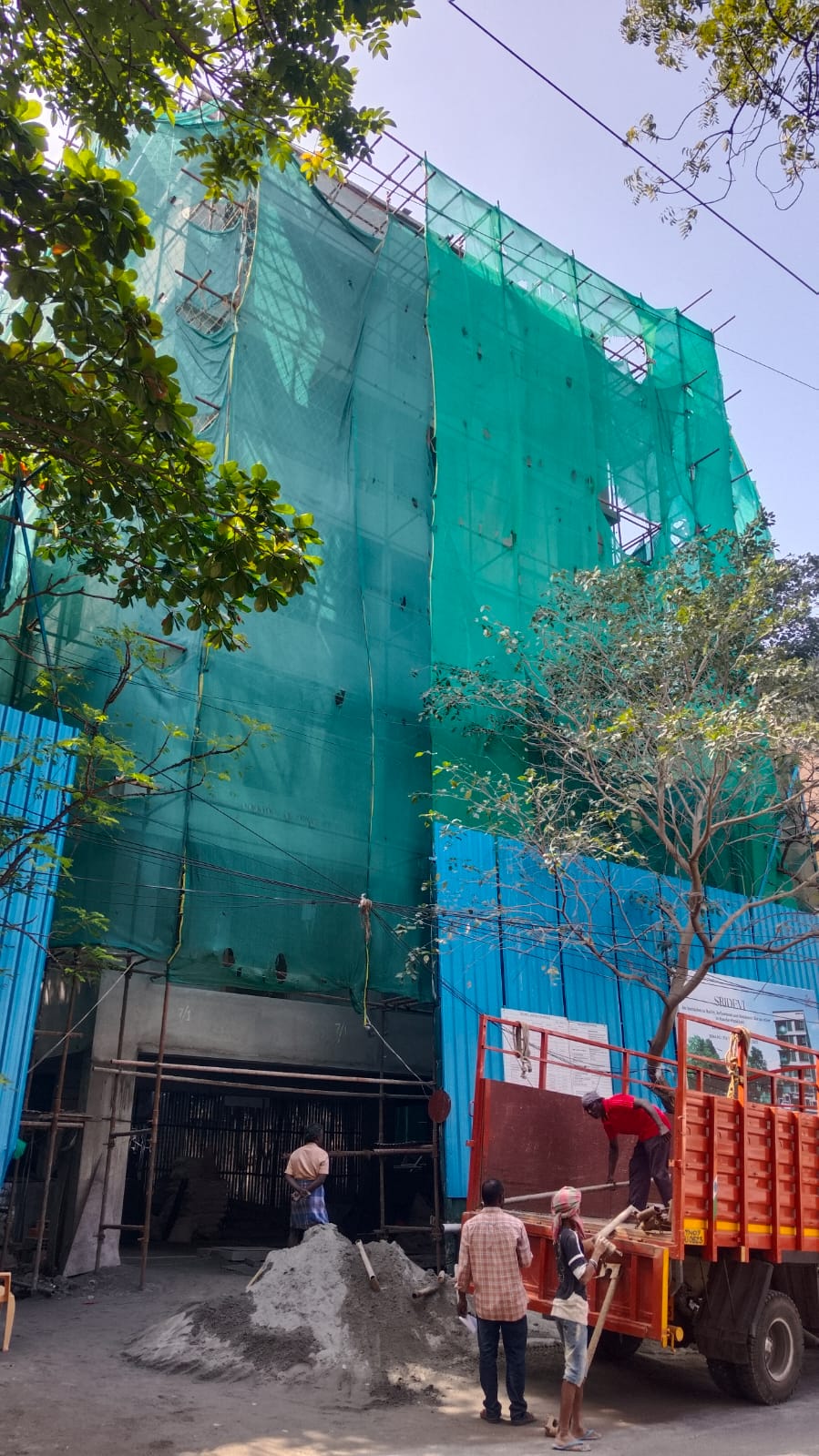

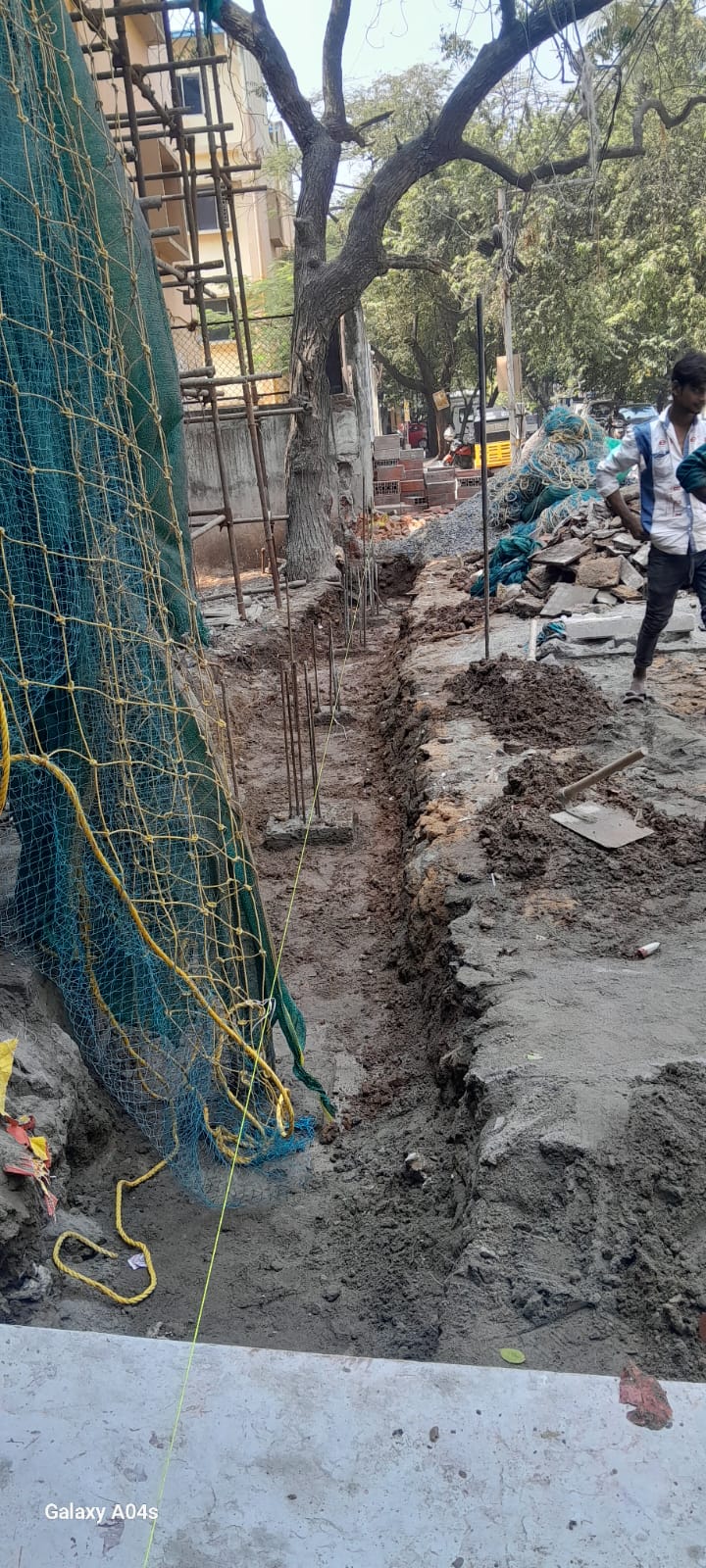

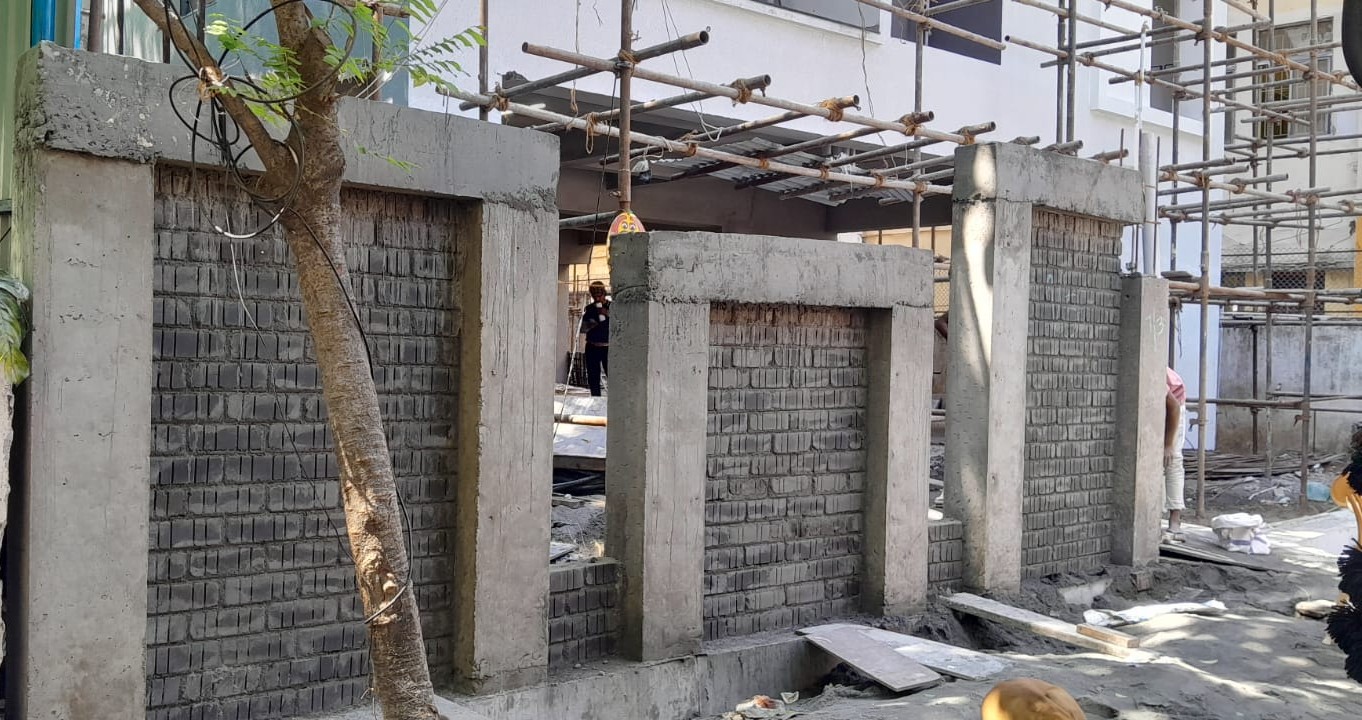

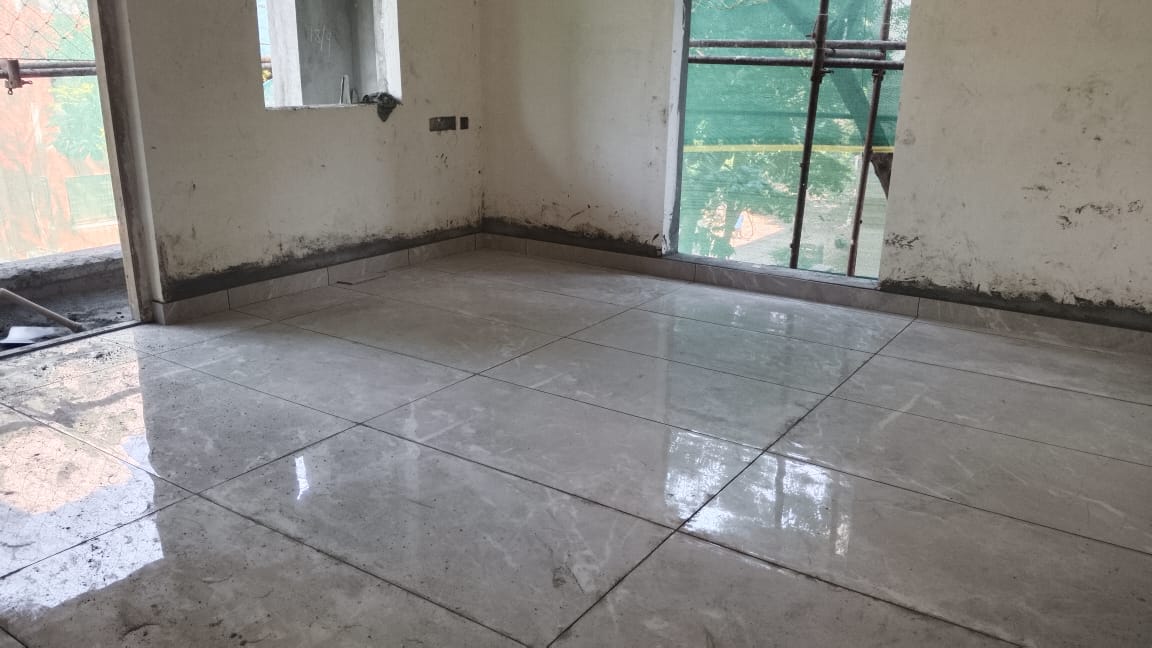

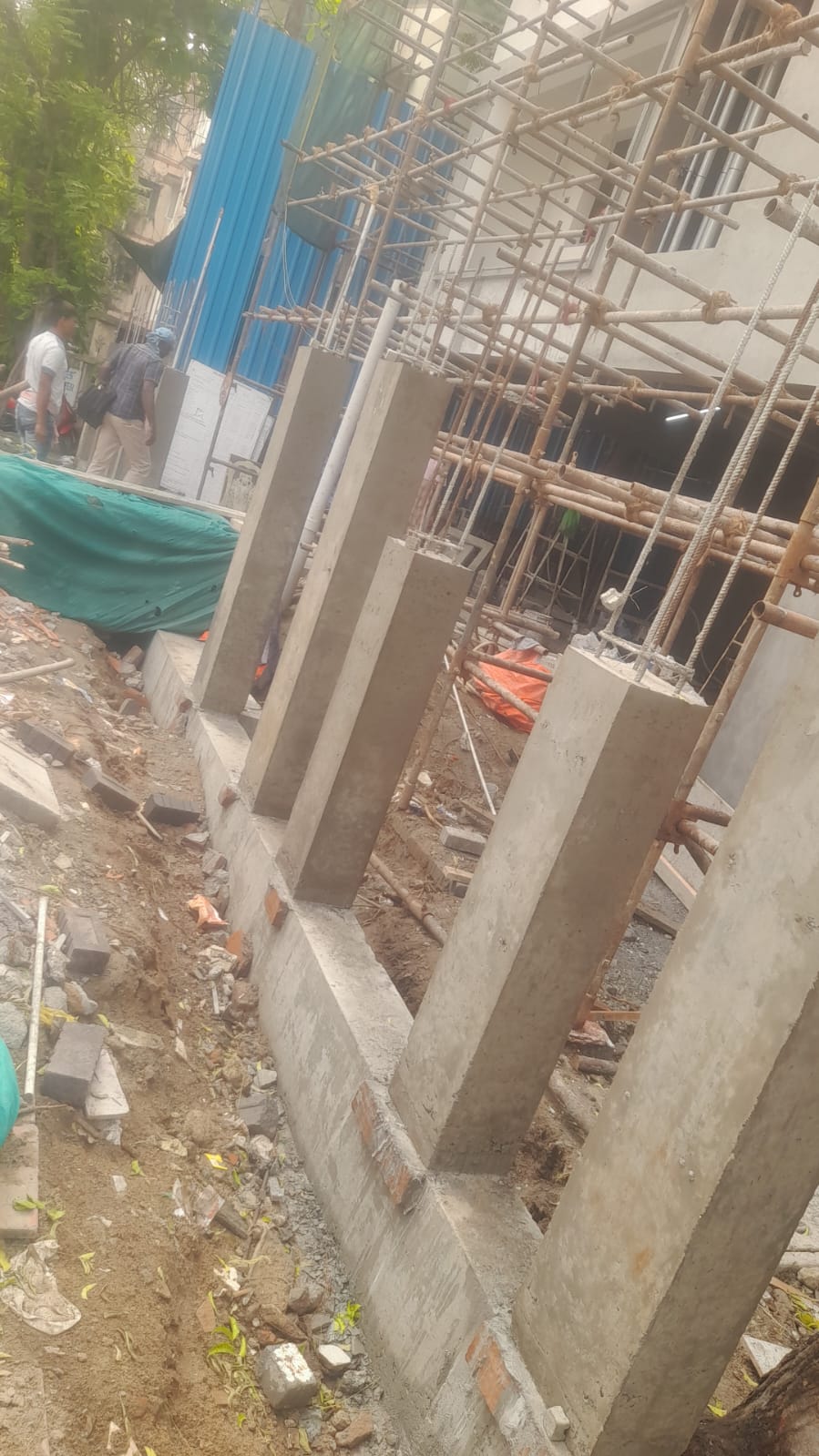

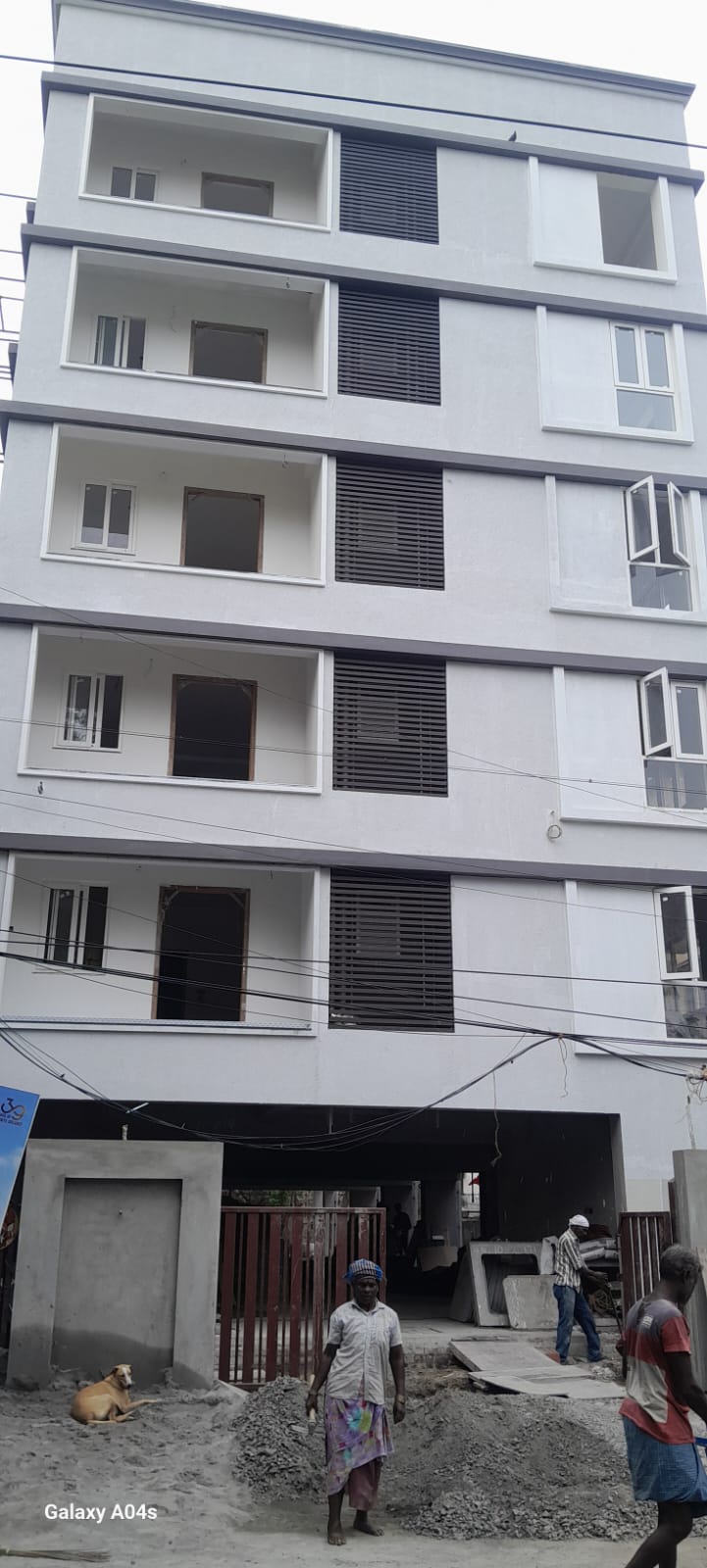

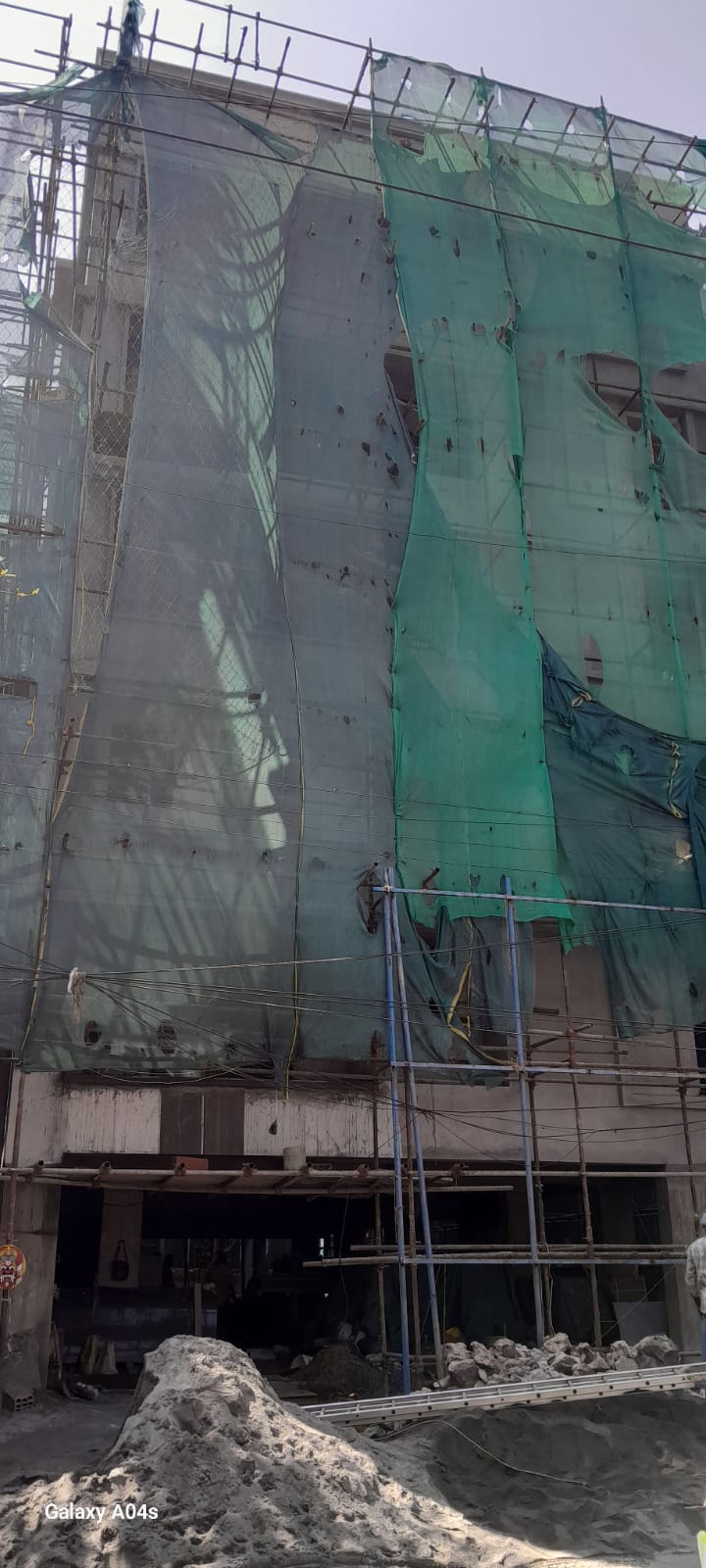

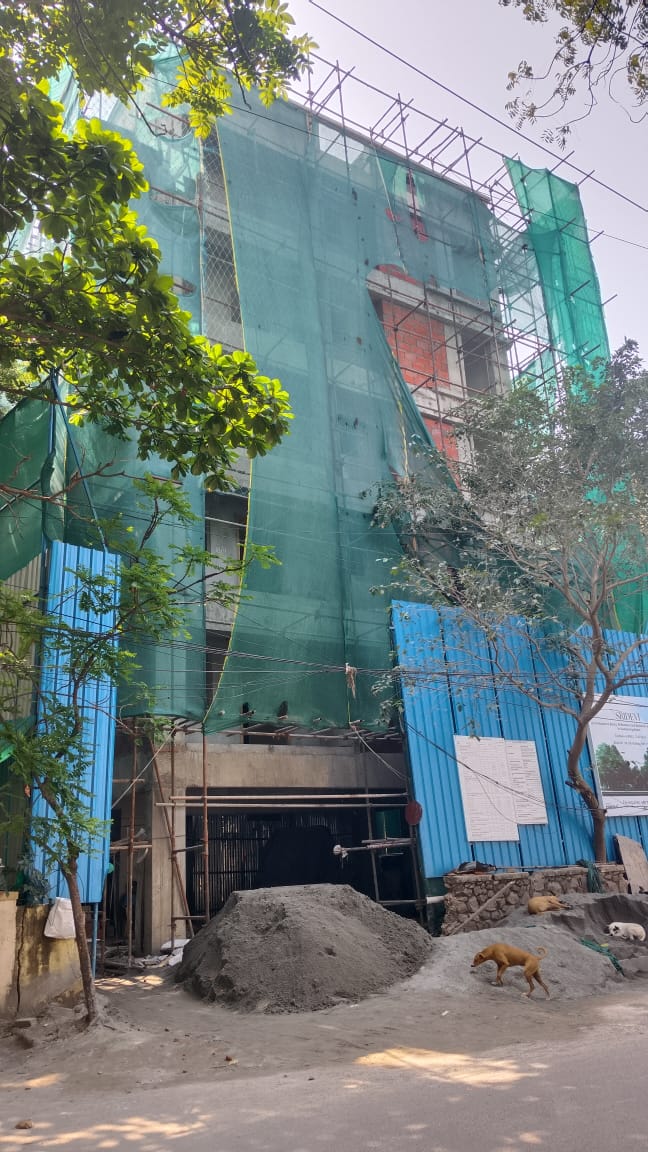

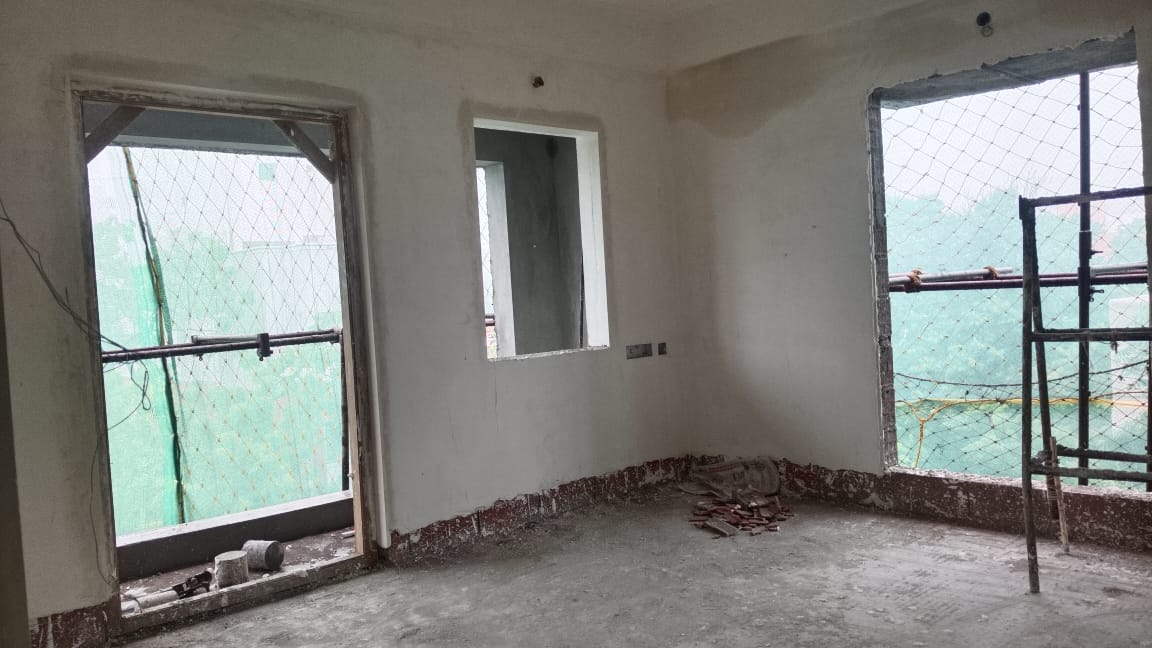

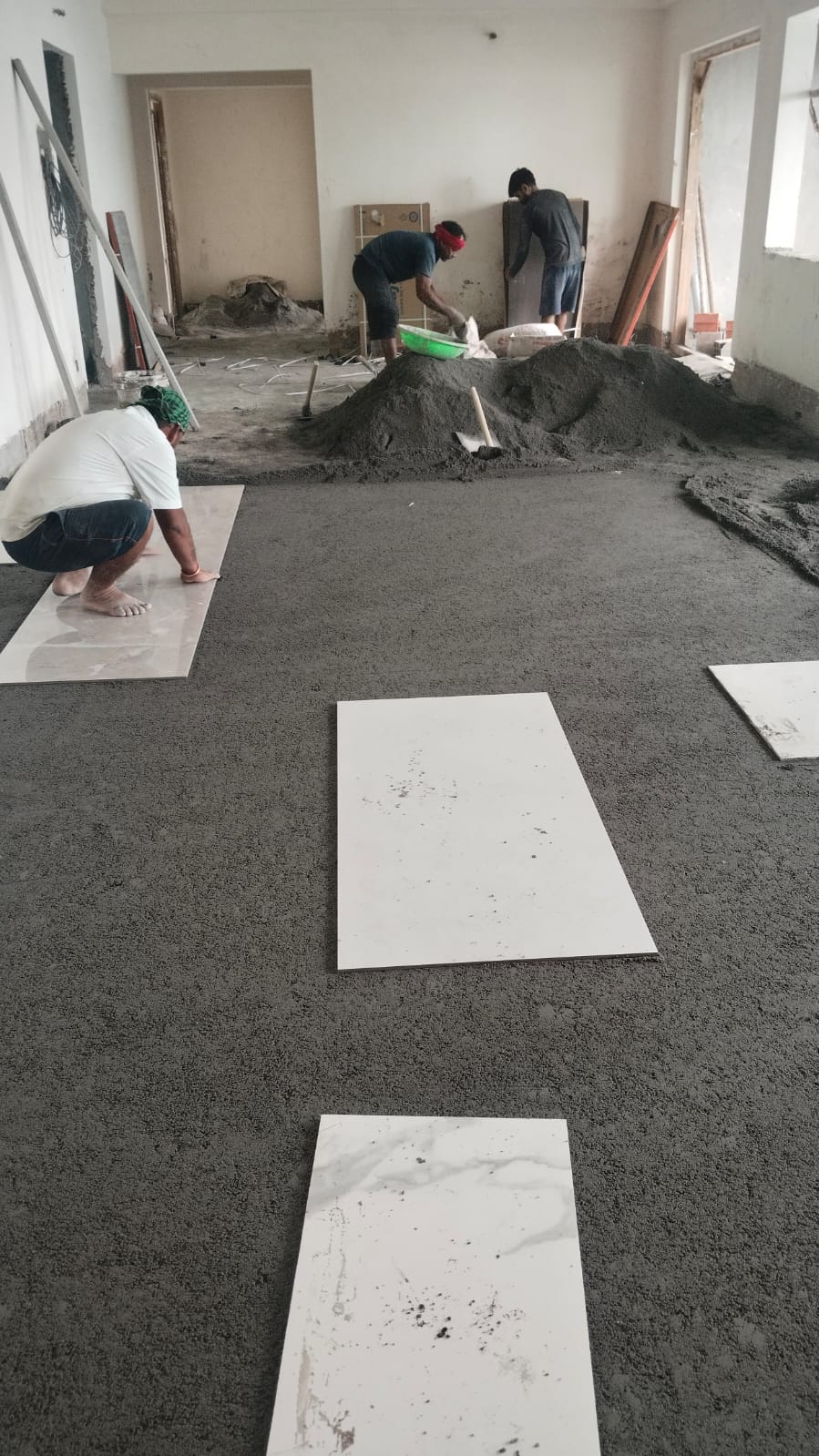

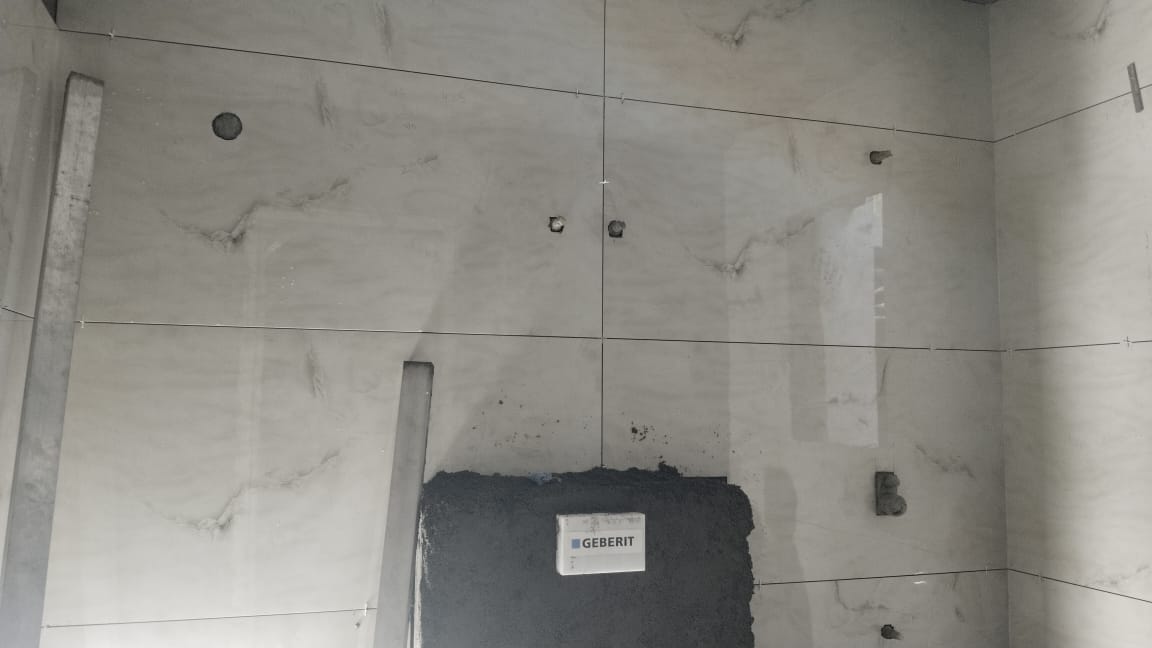

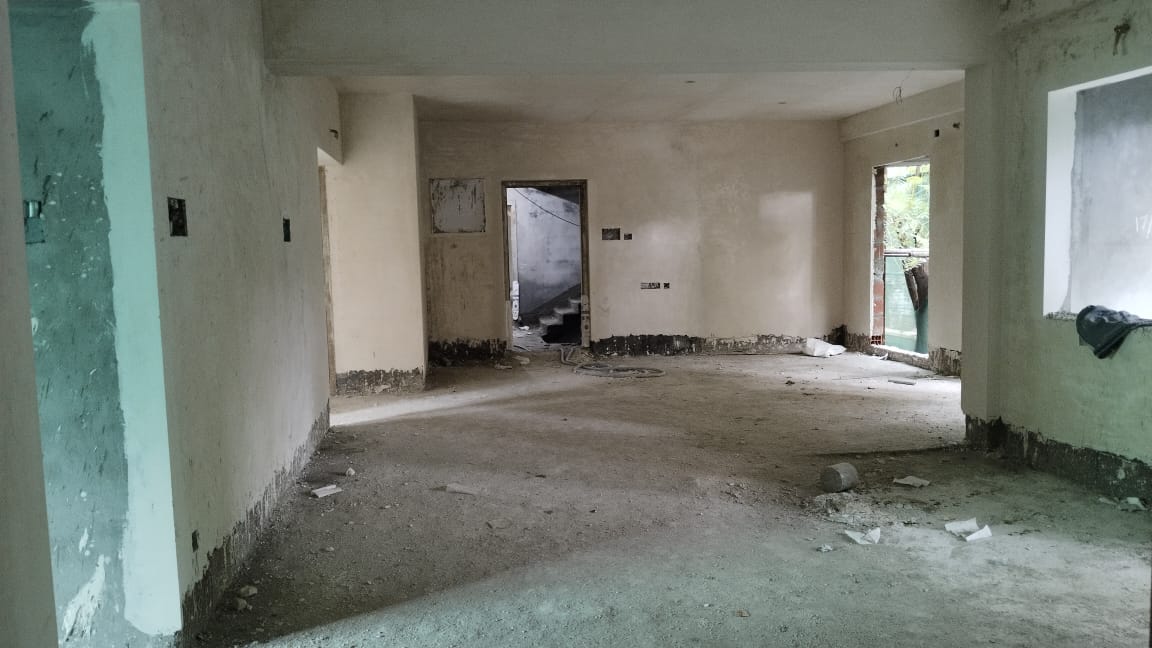

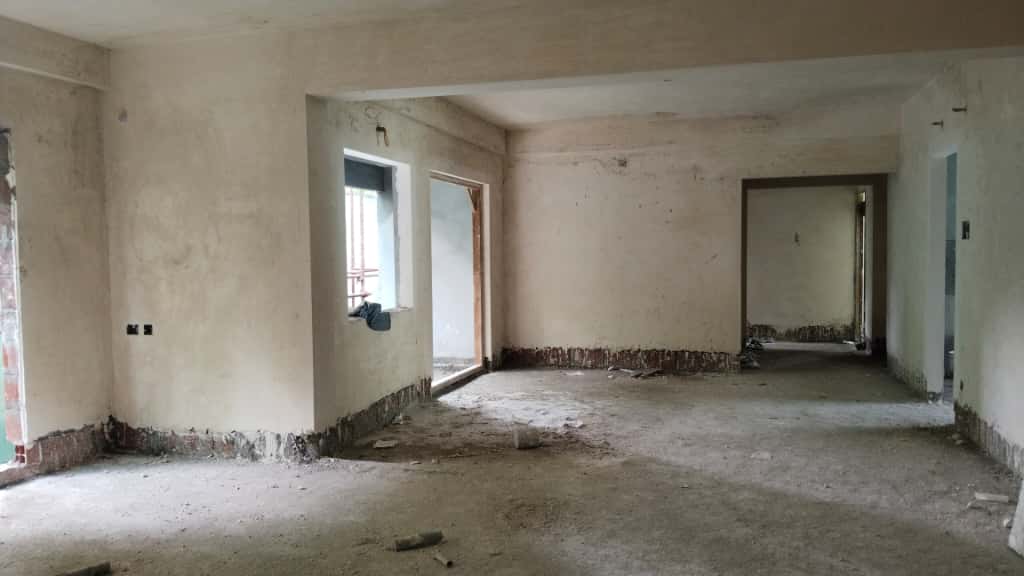

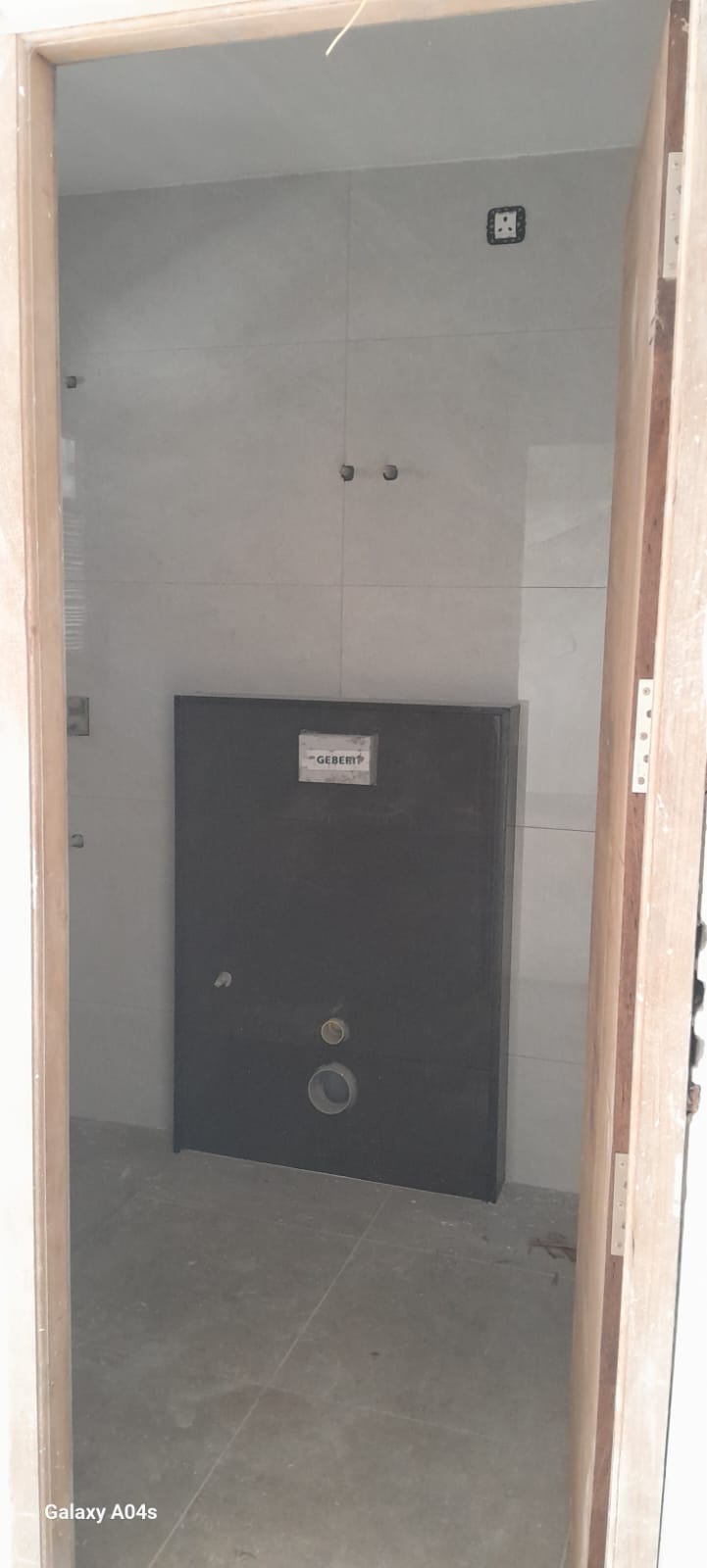

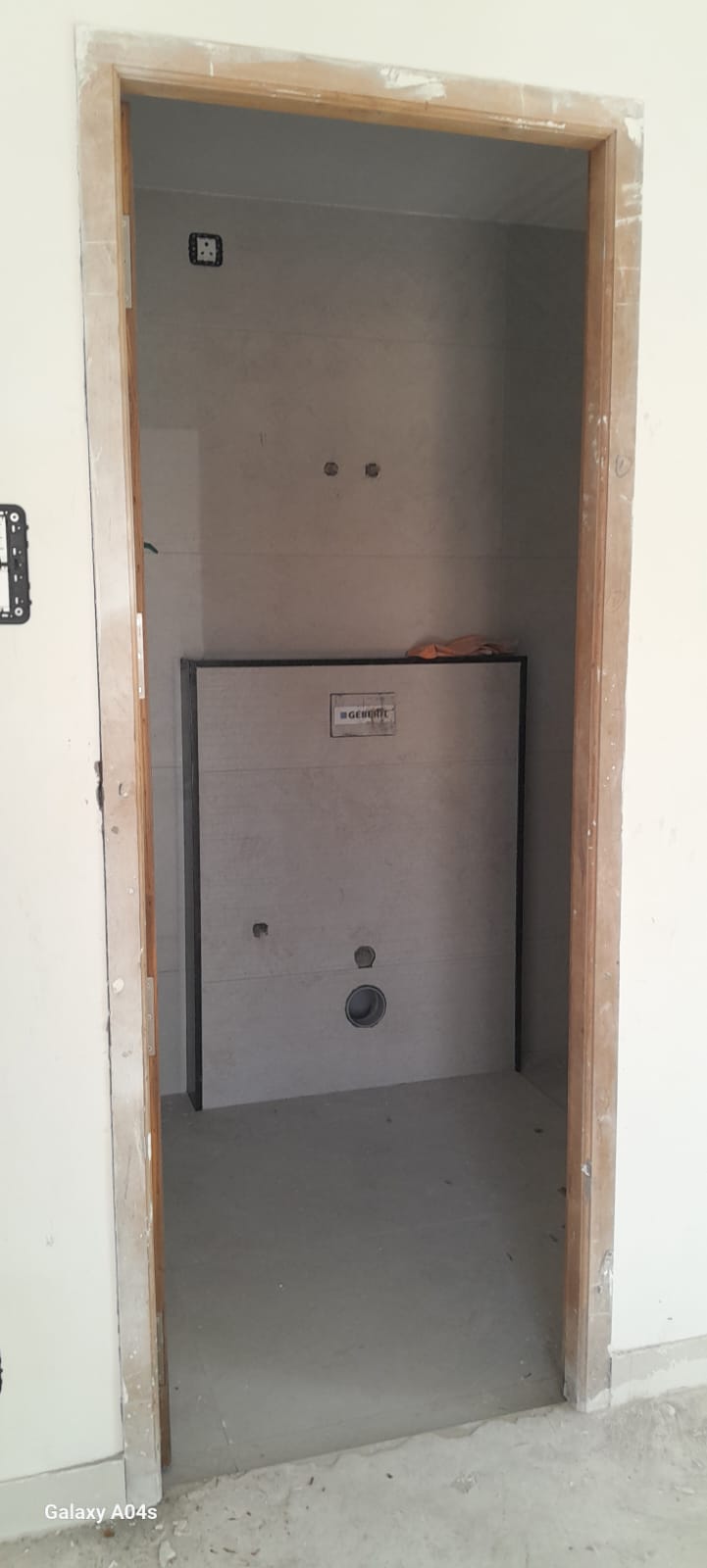

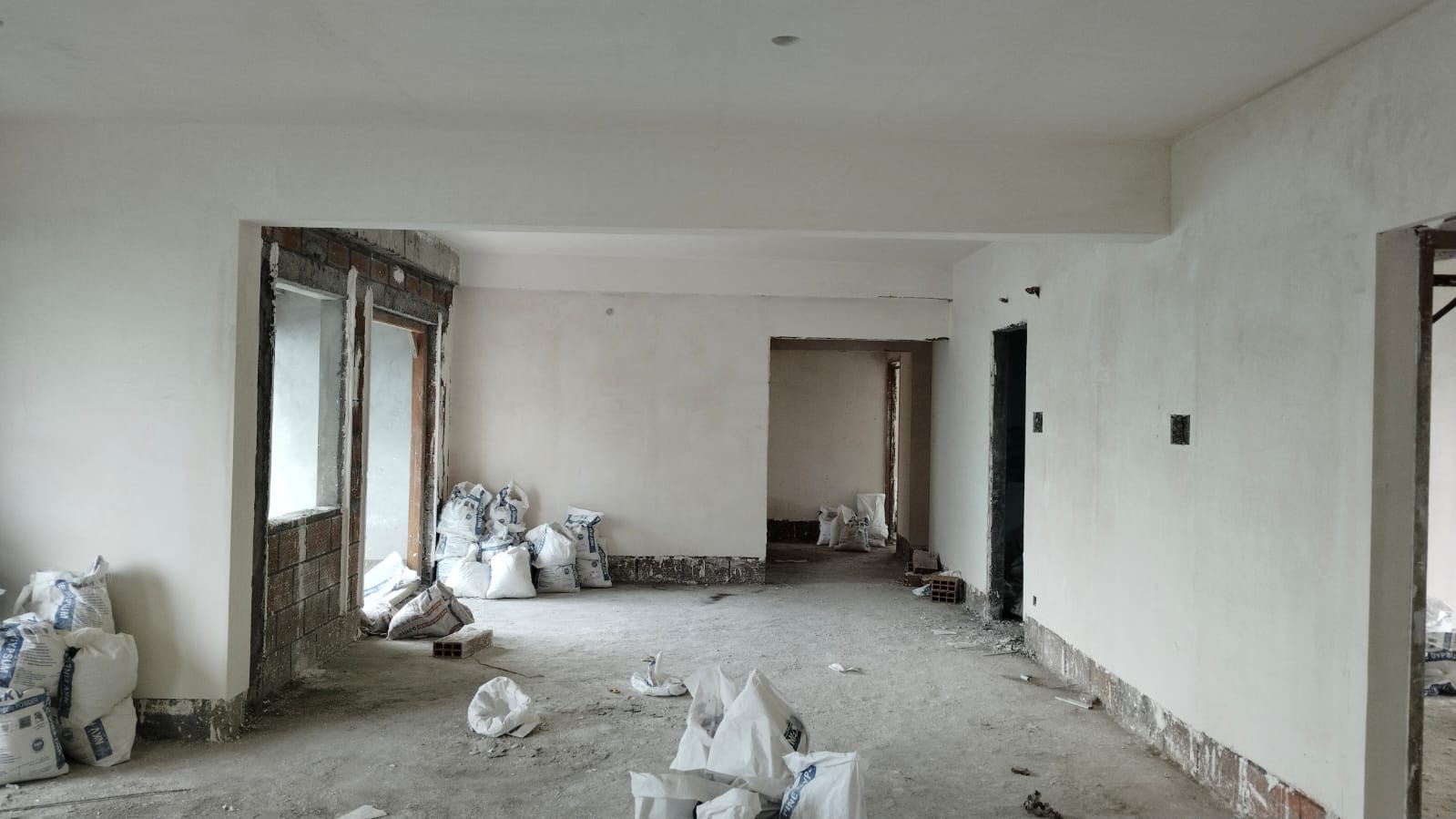

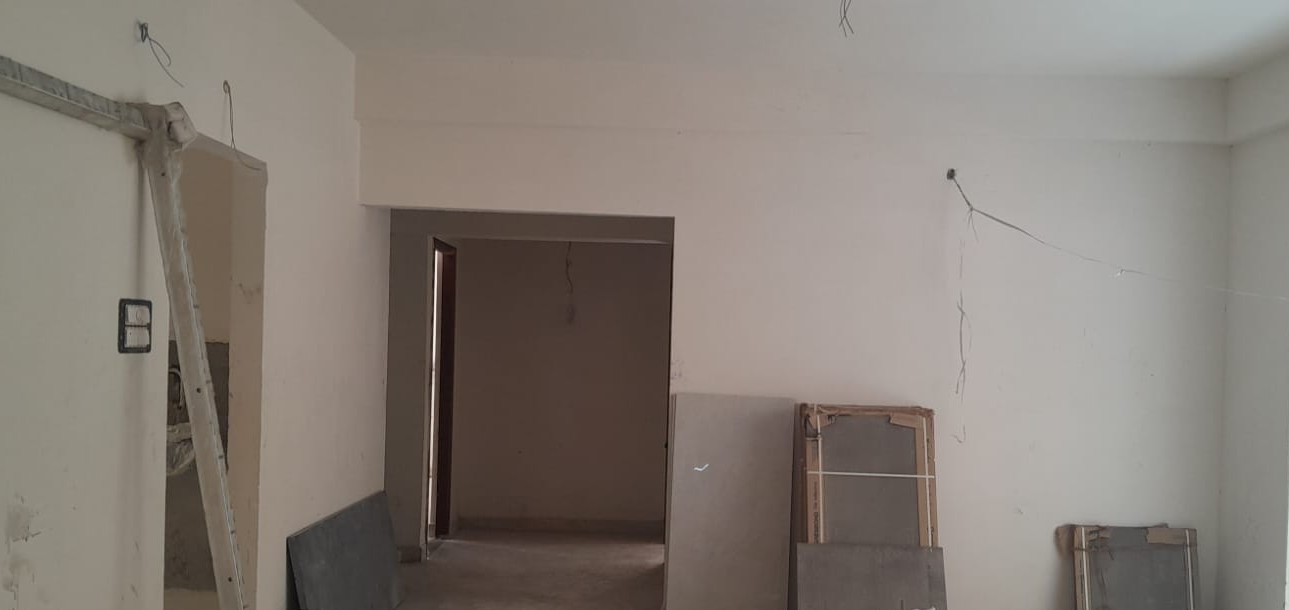

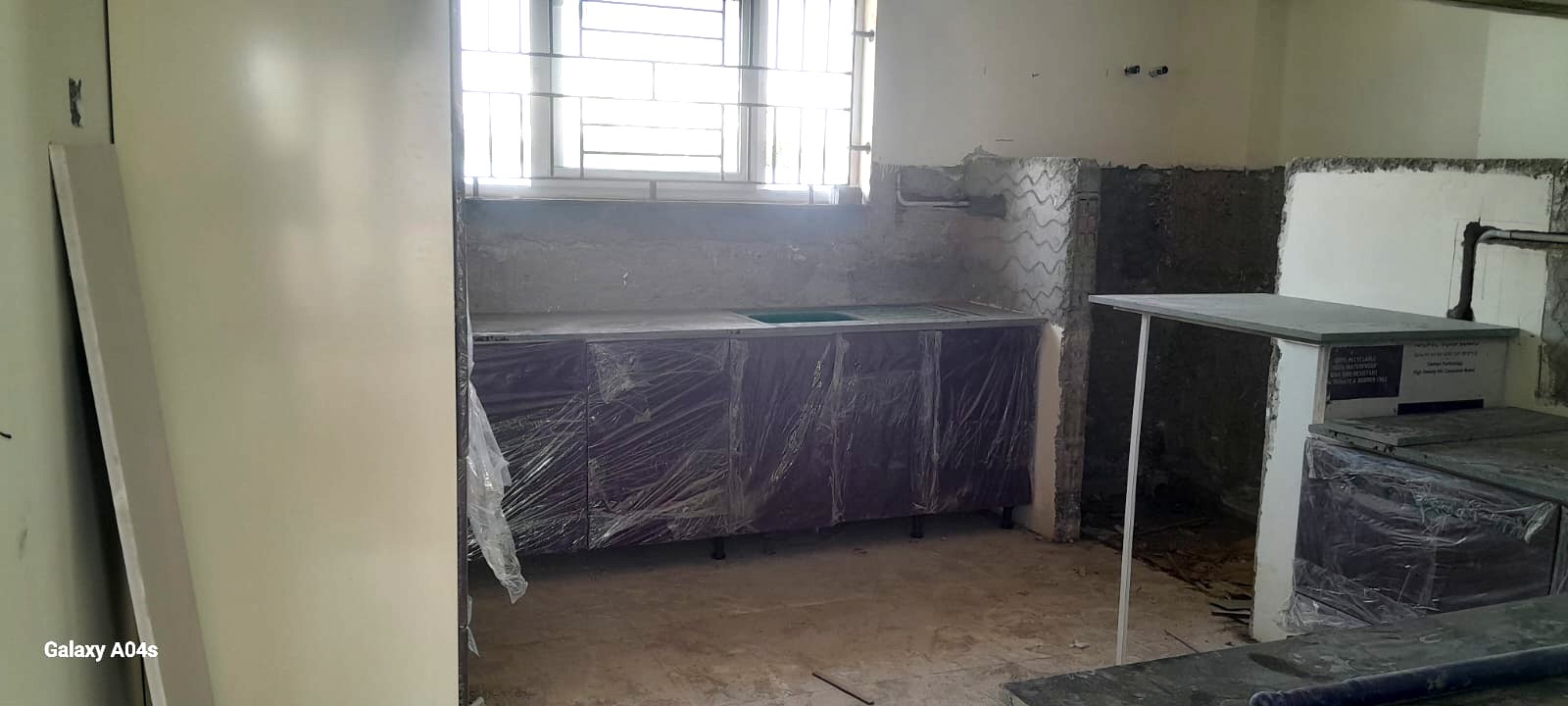

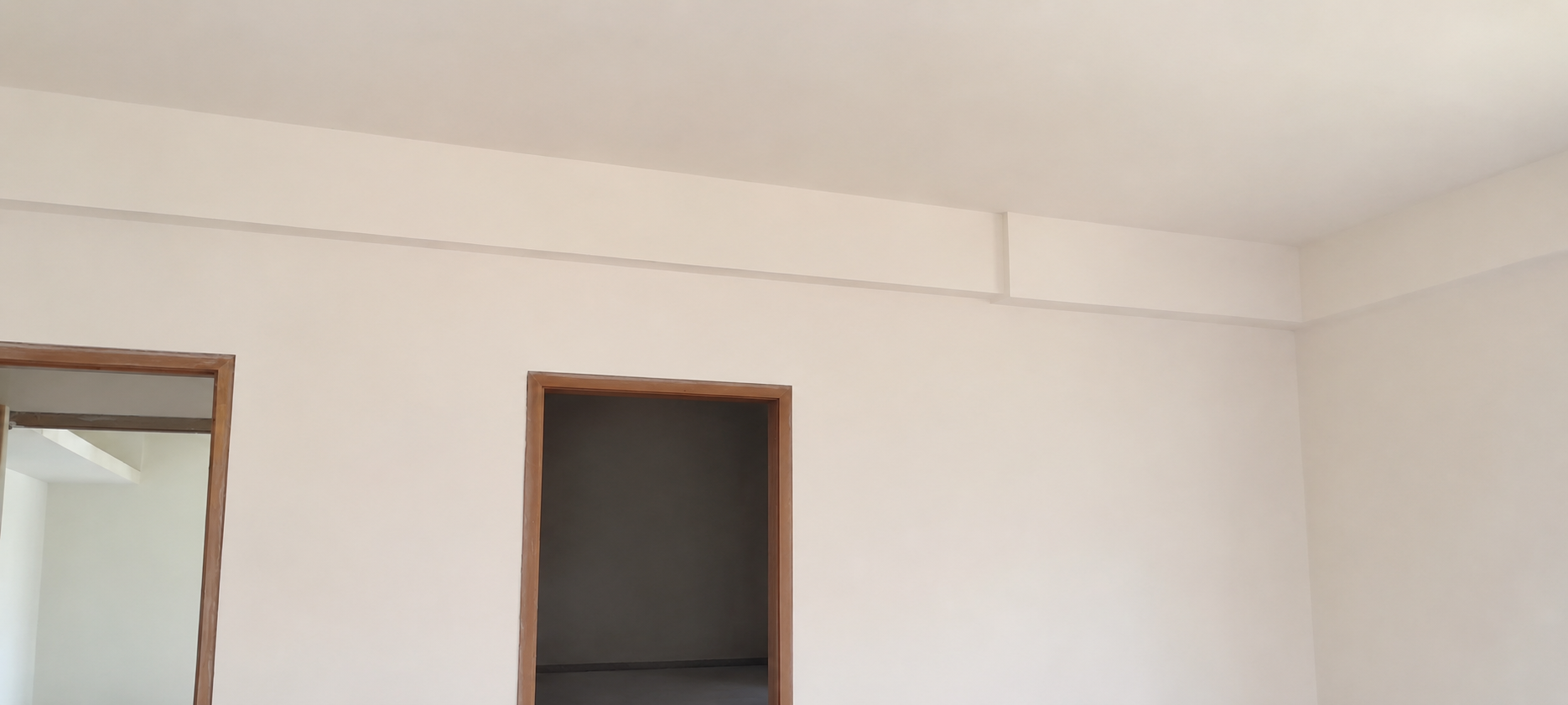

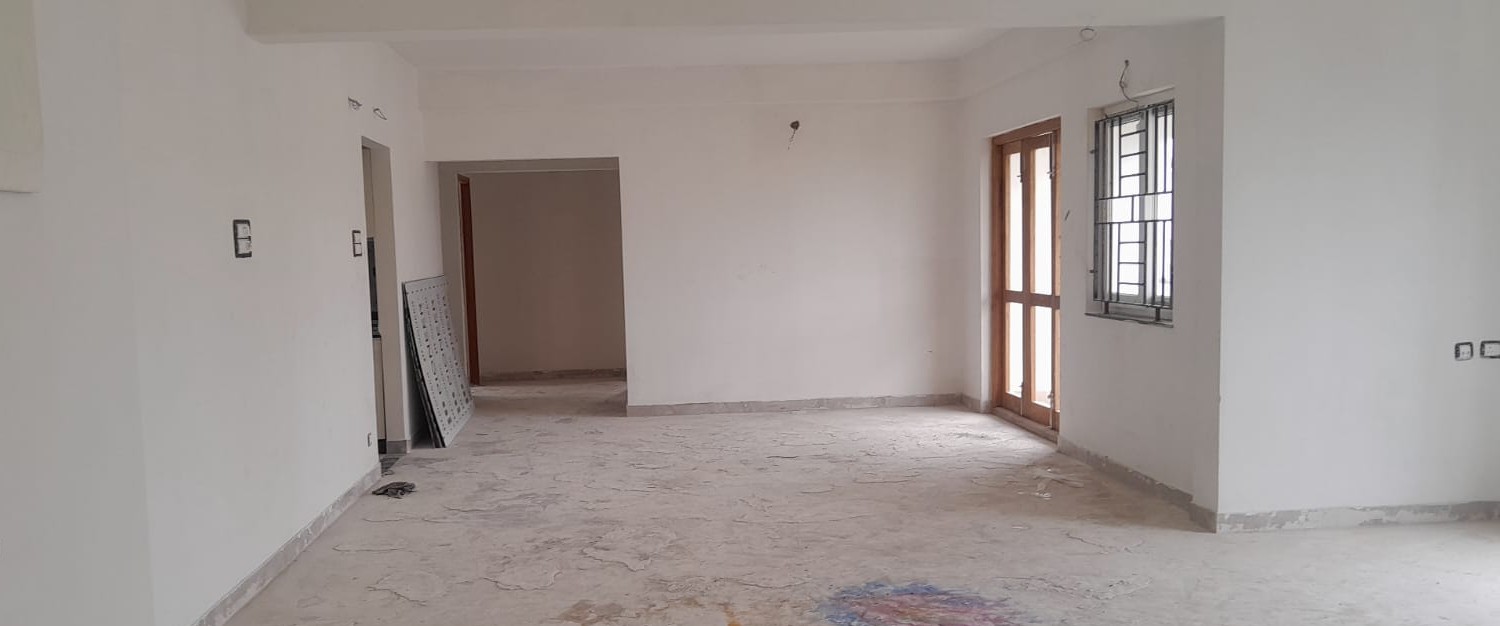

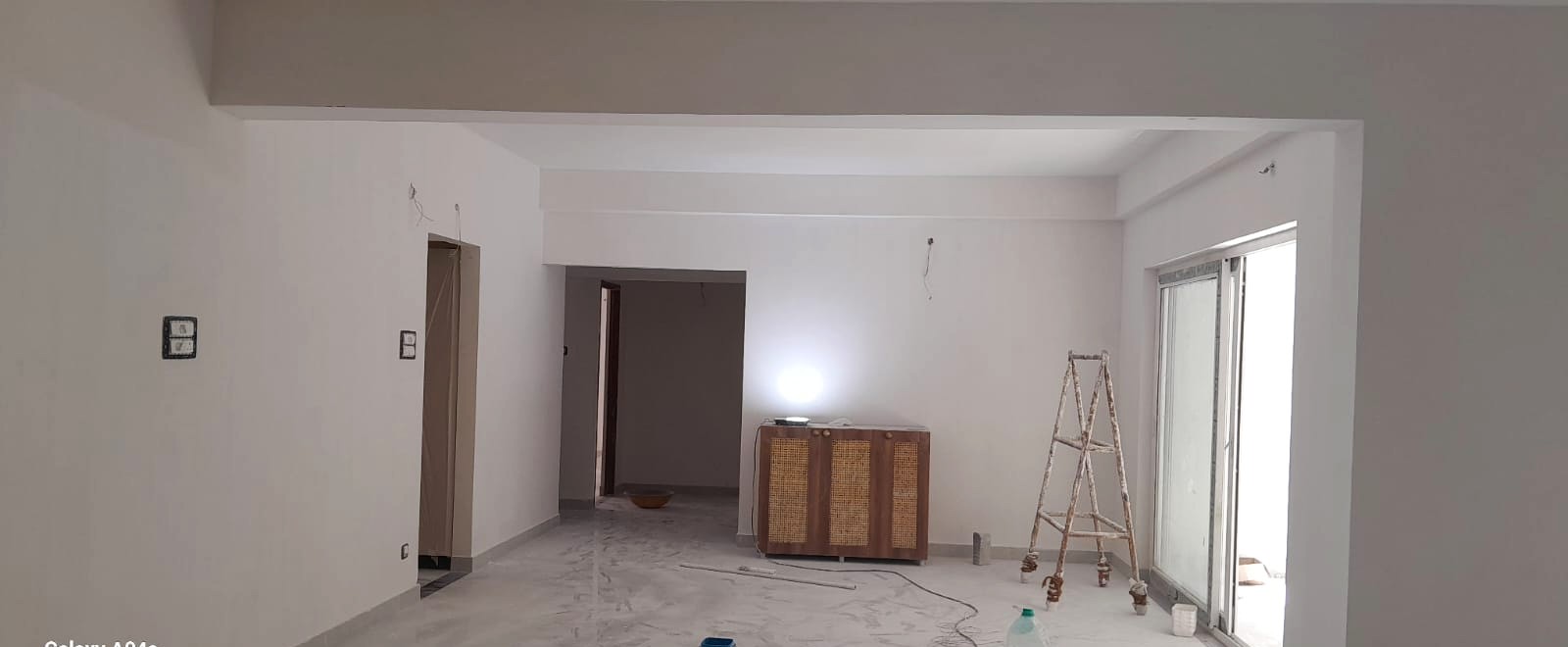

  • General flooring work is in progress.(Up to 4th floor completed,5th floor 90% completed)

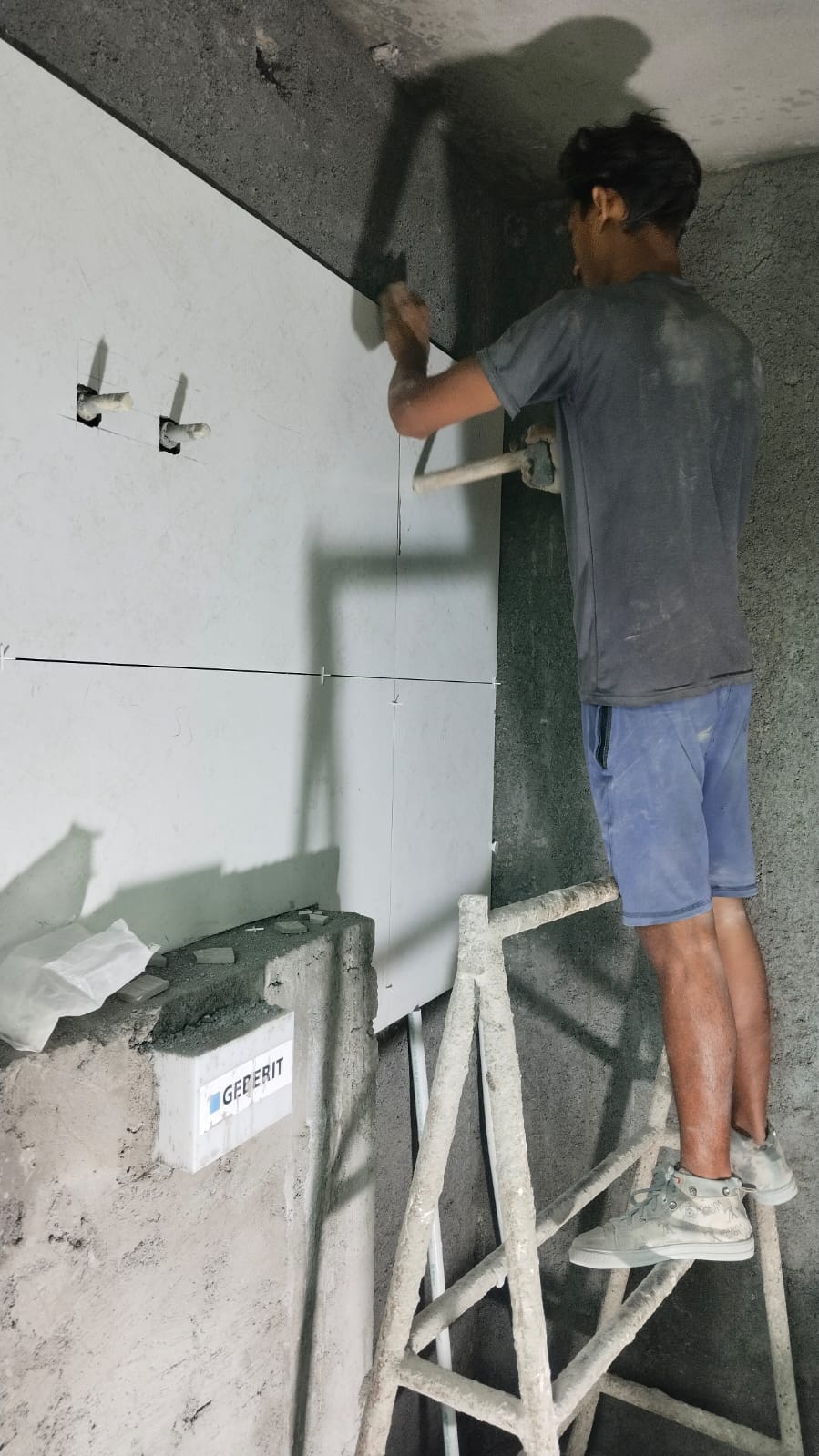

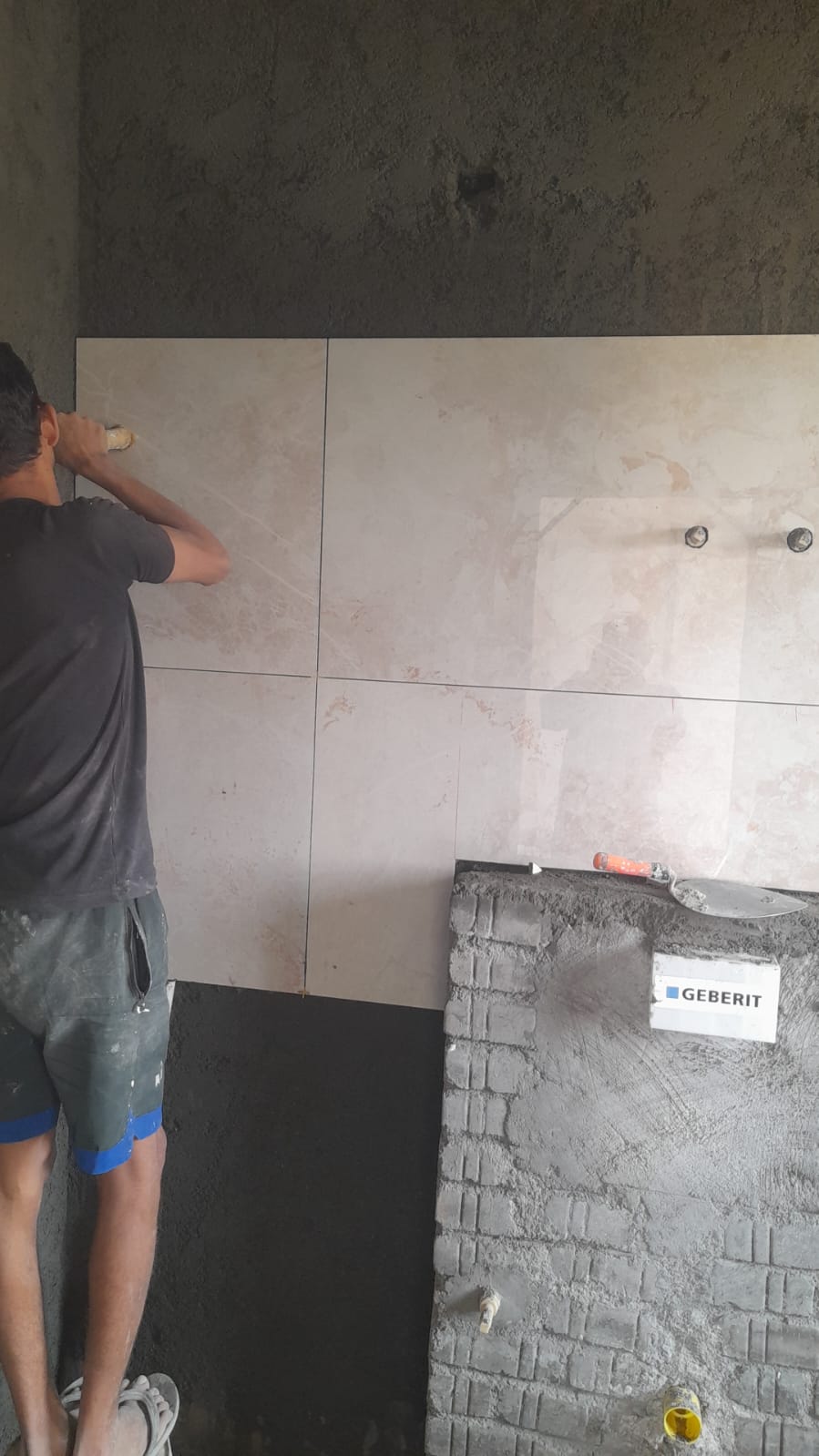

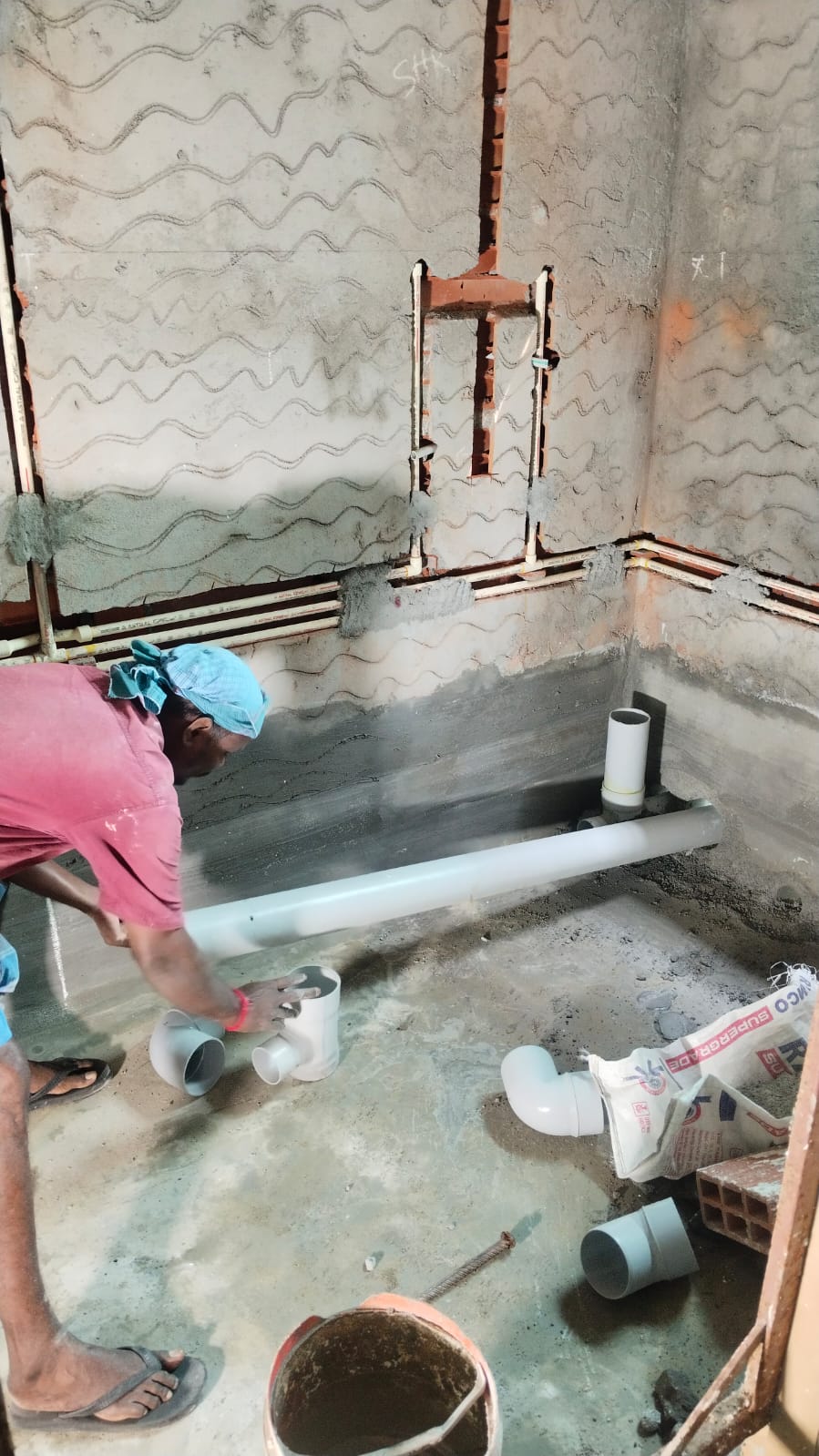

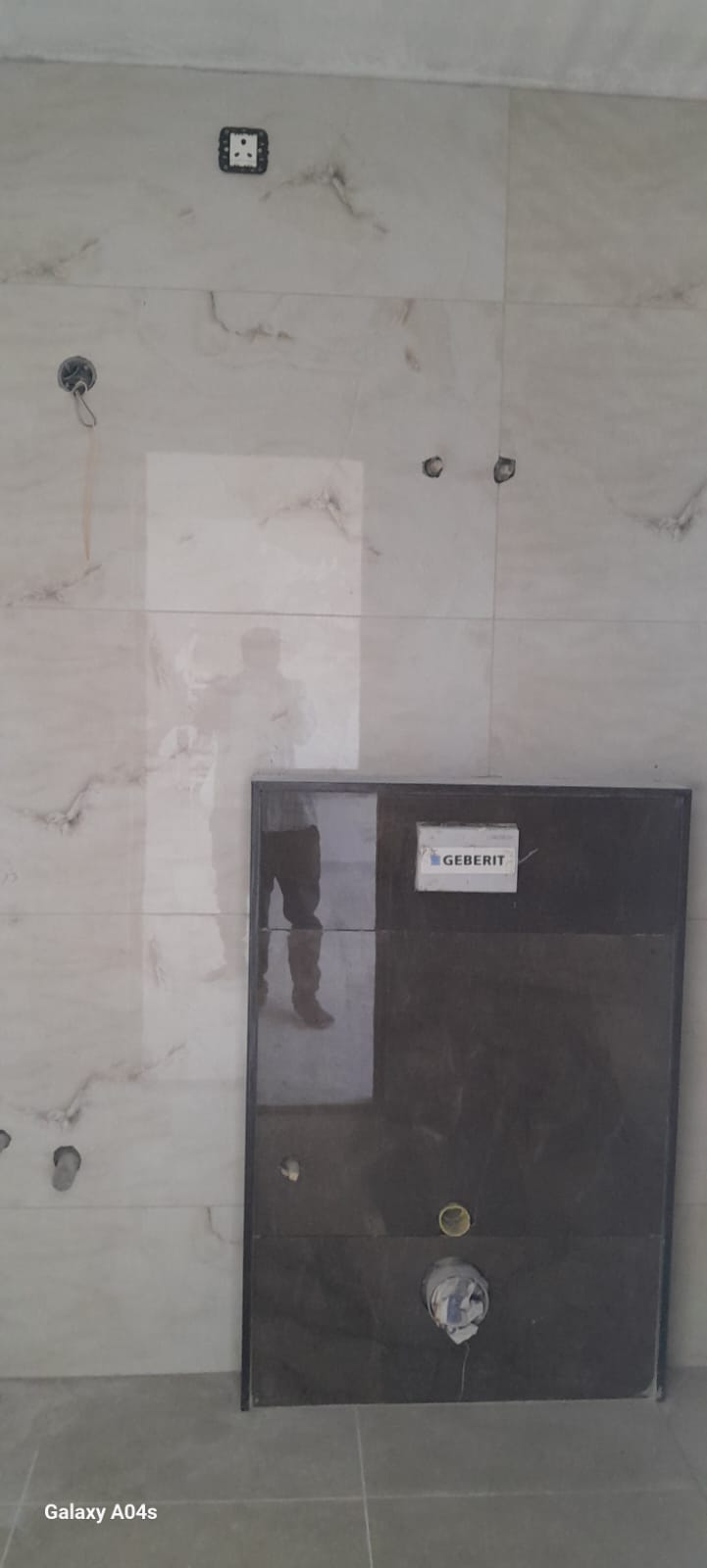

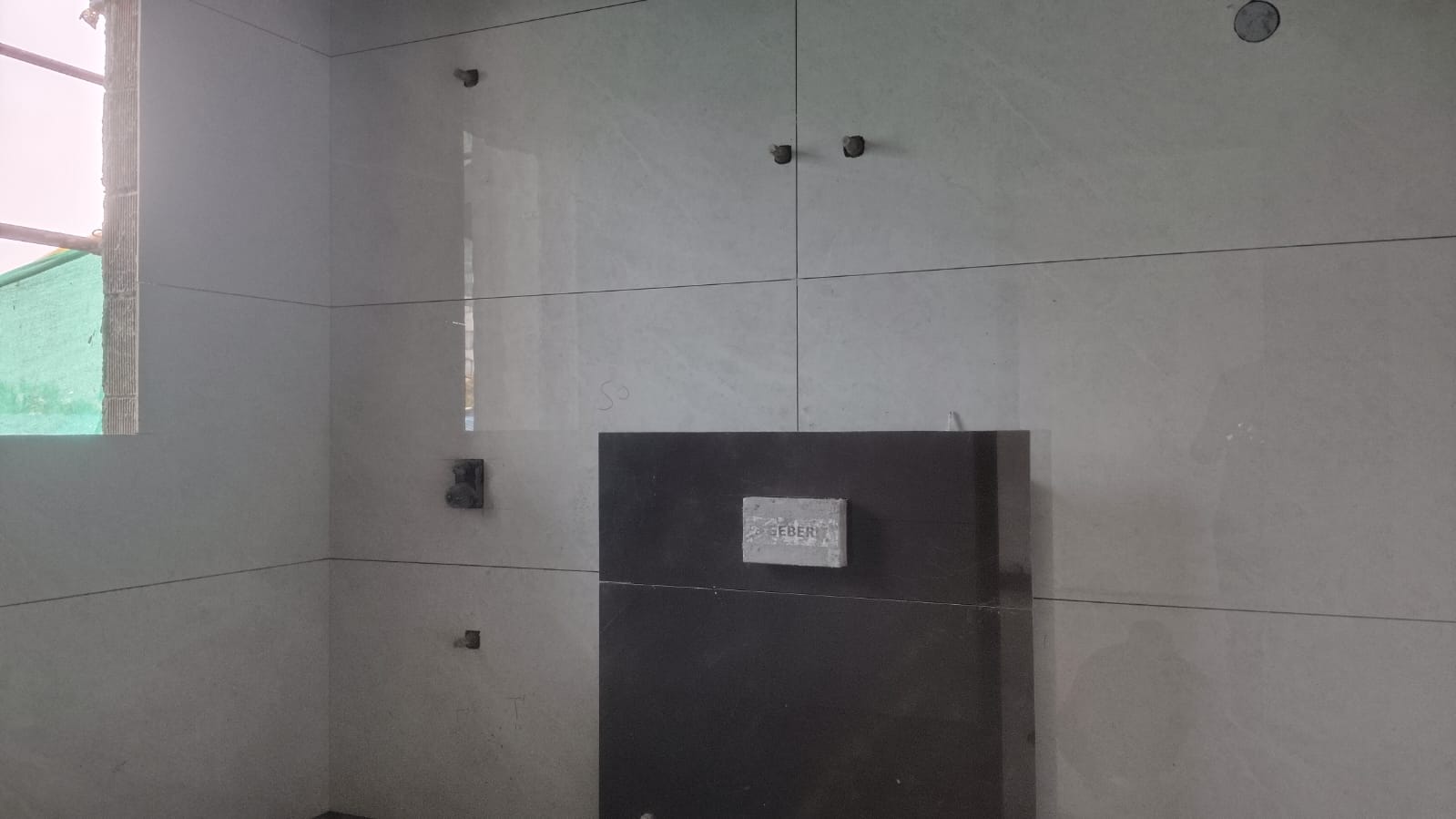

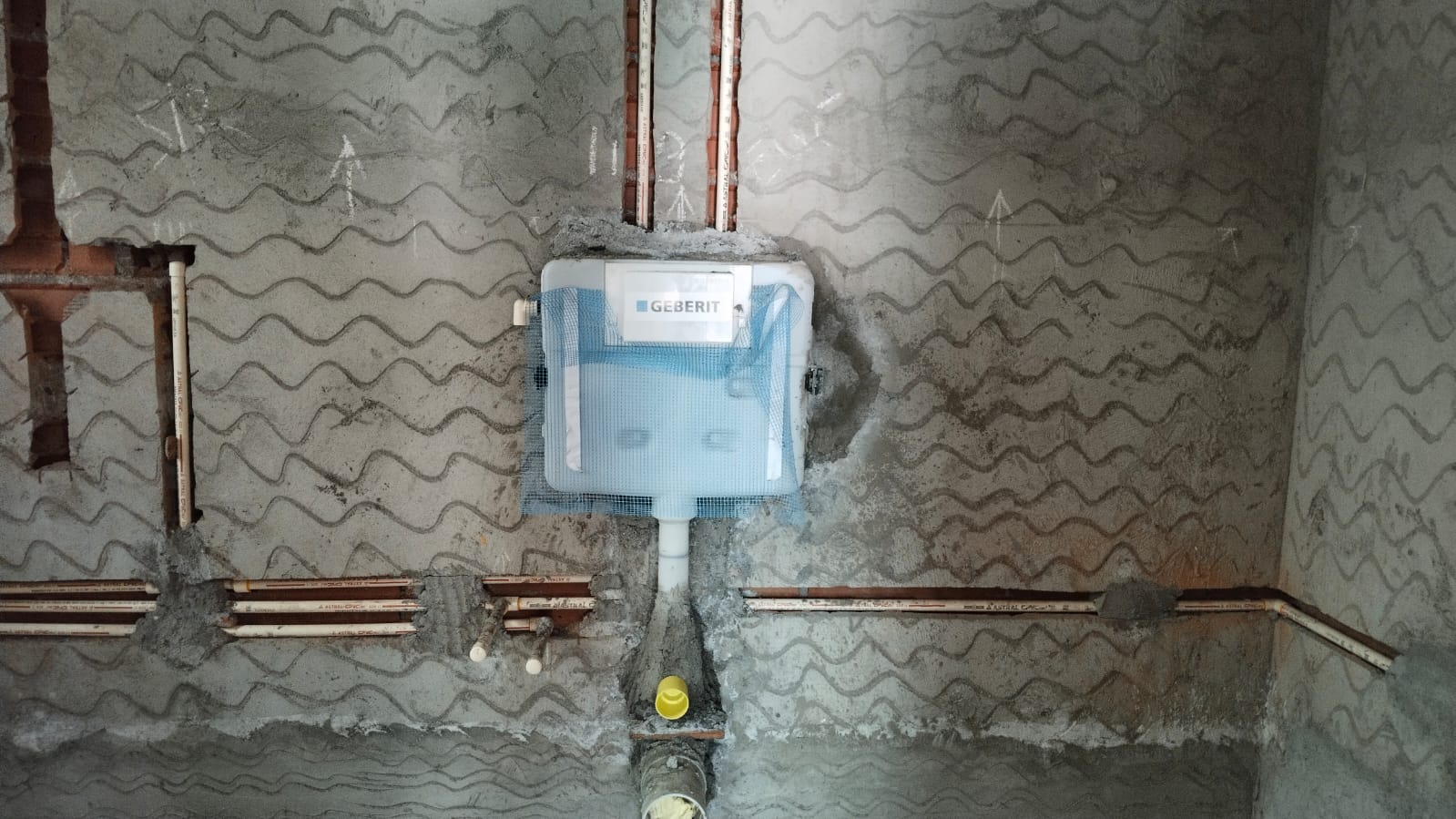

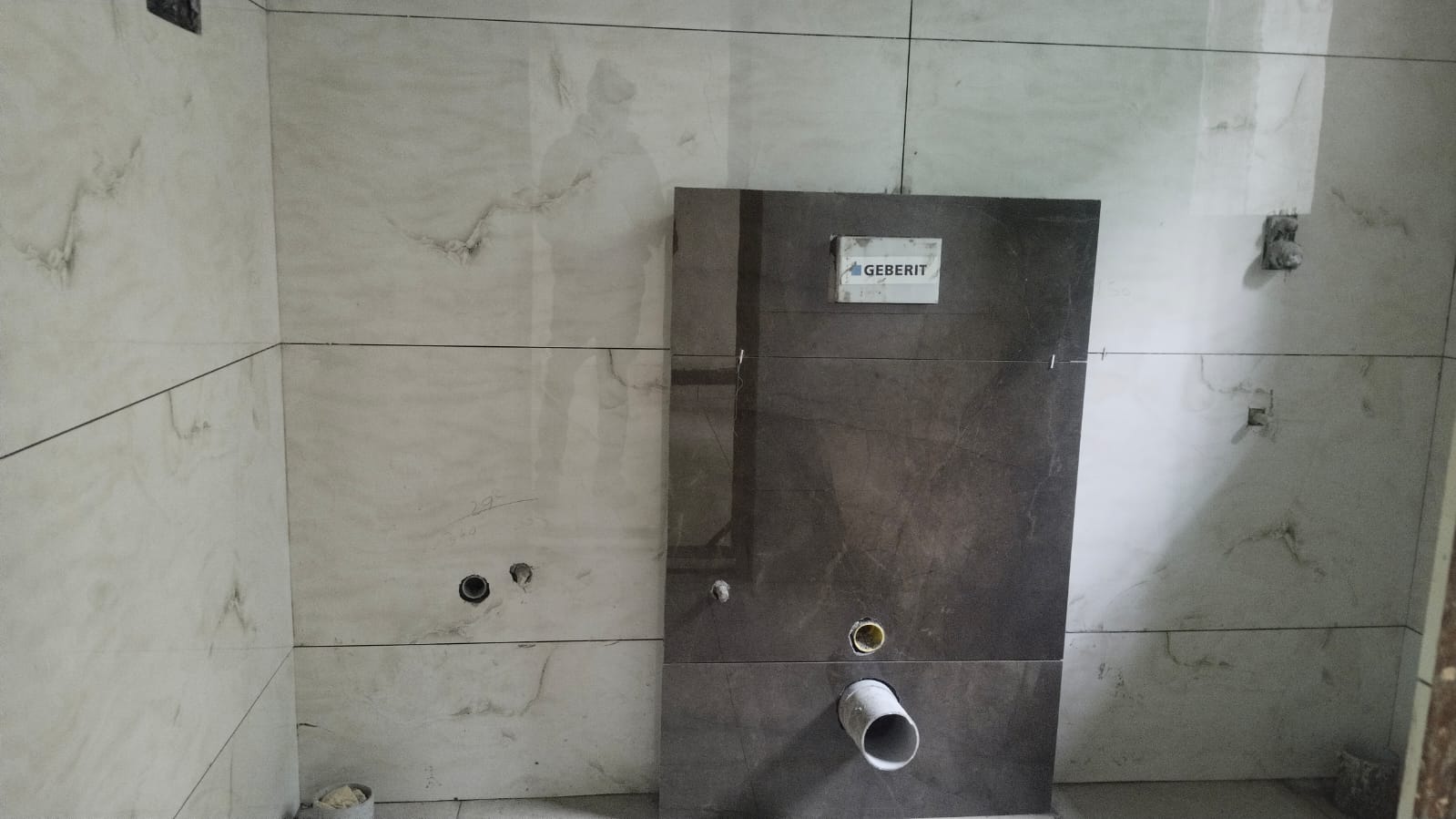

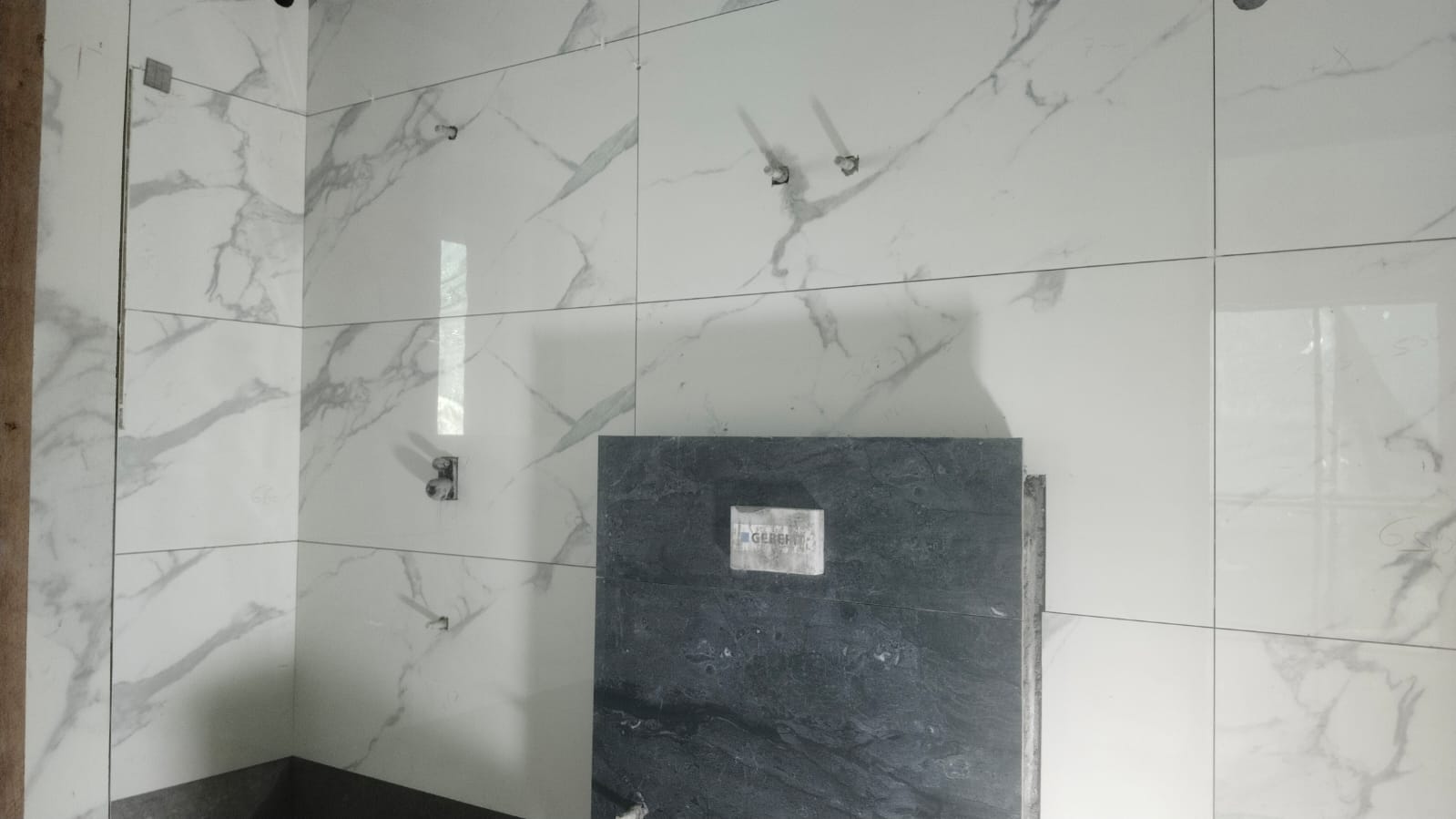

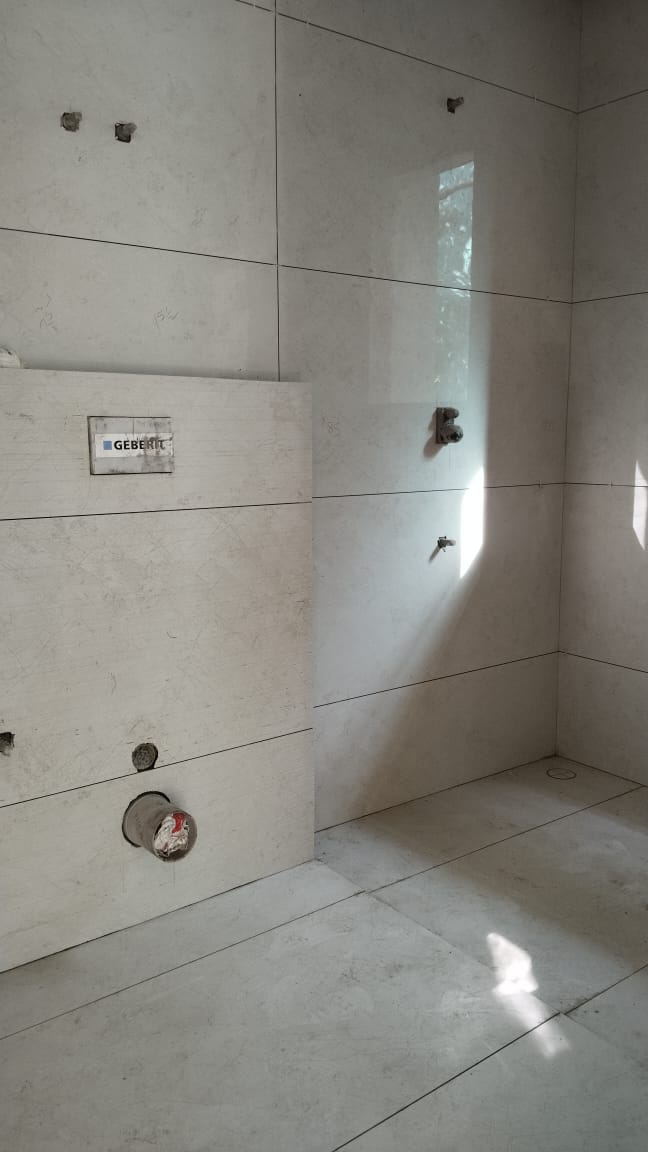

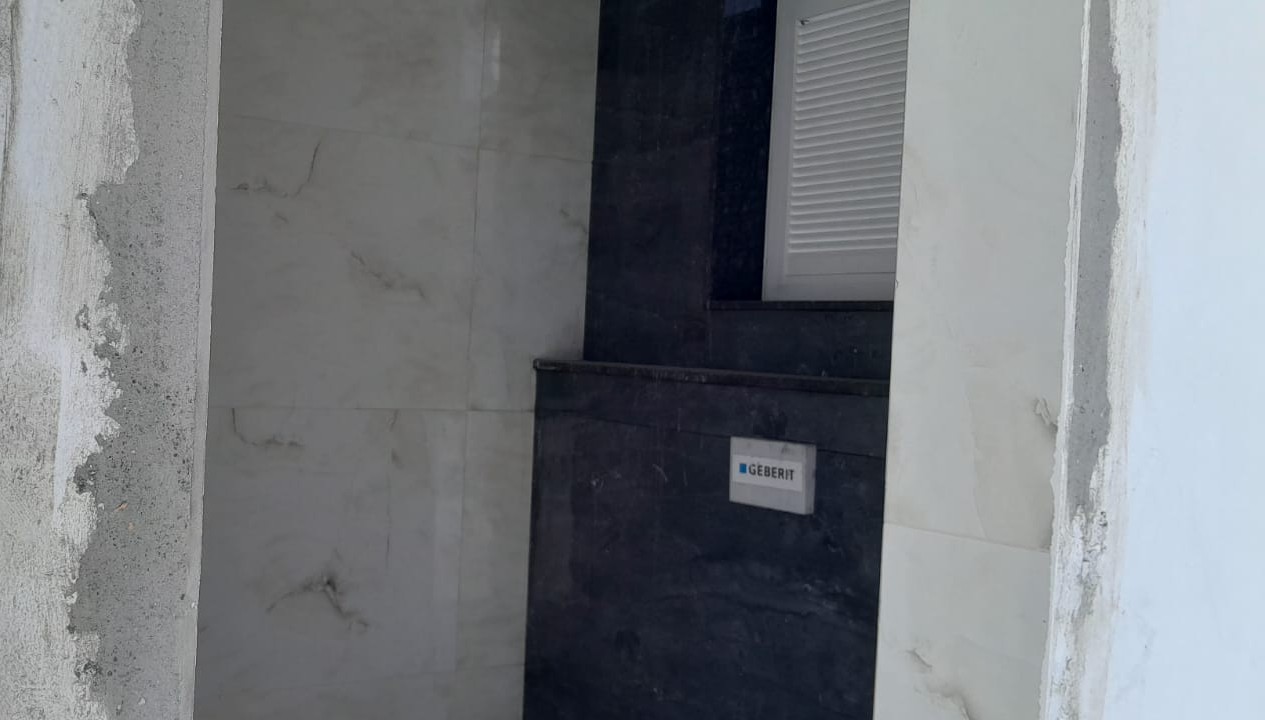

  • Toilet tiles work is in progress.(Up to 4thfloor completed , 5th floor 90% completed)

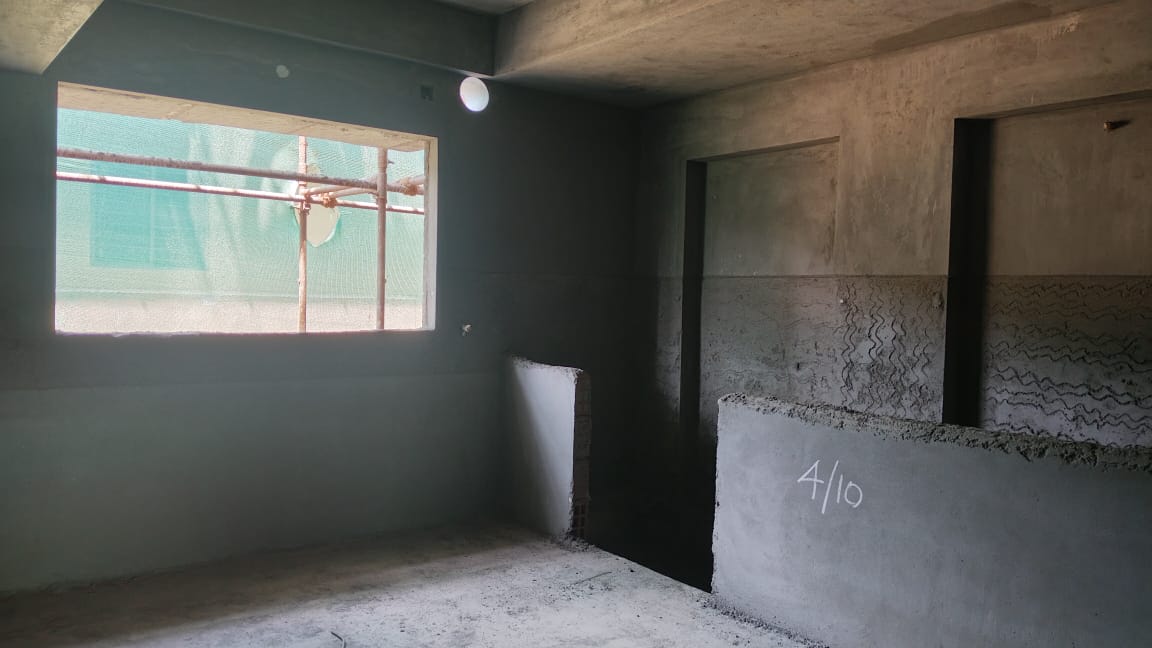

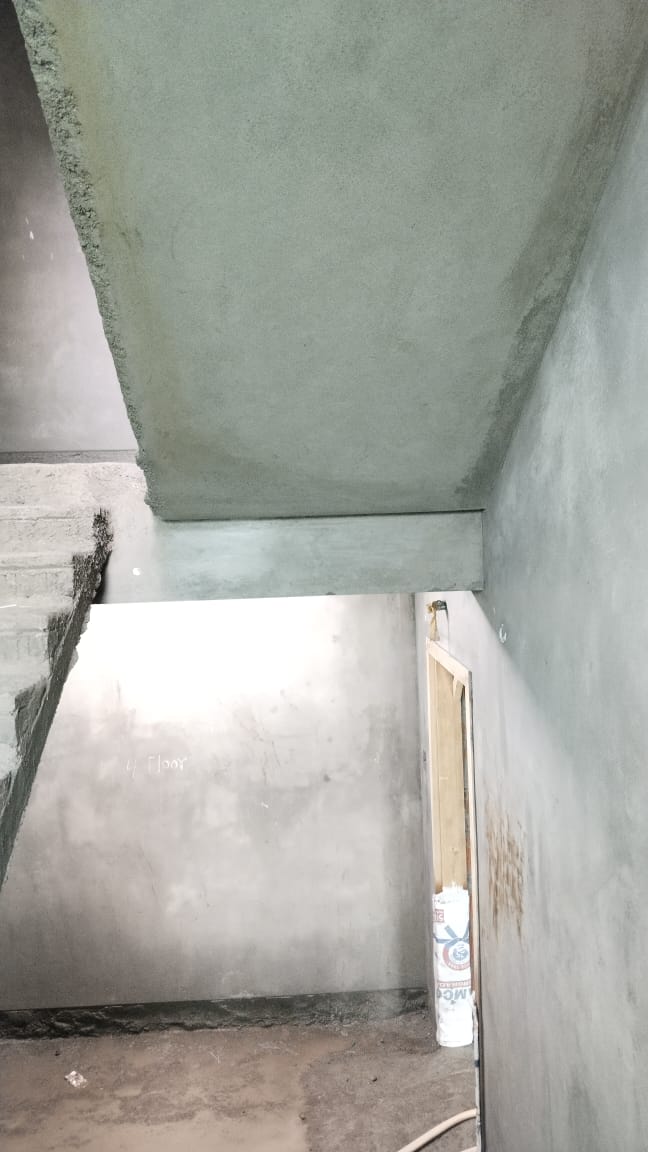

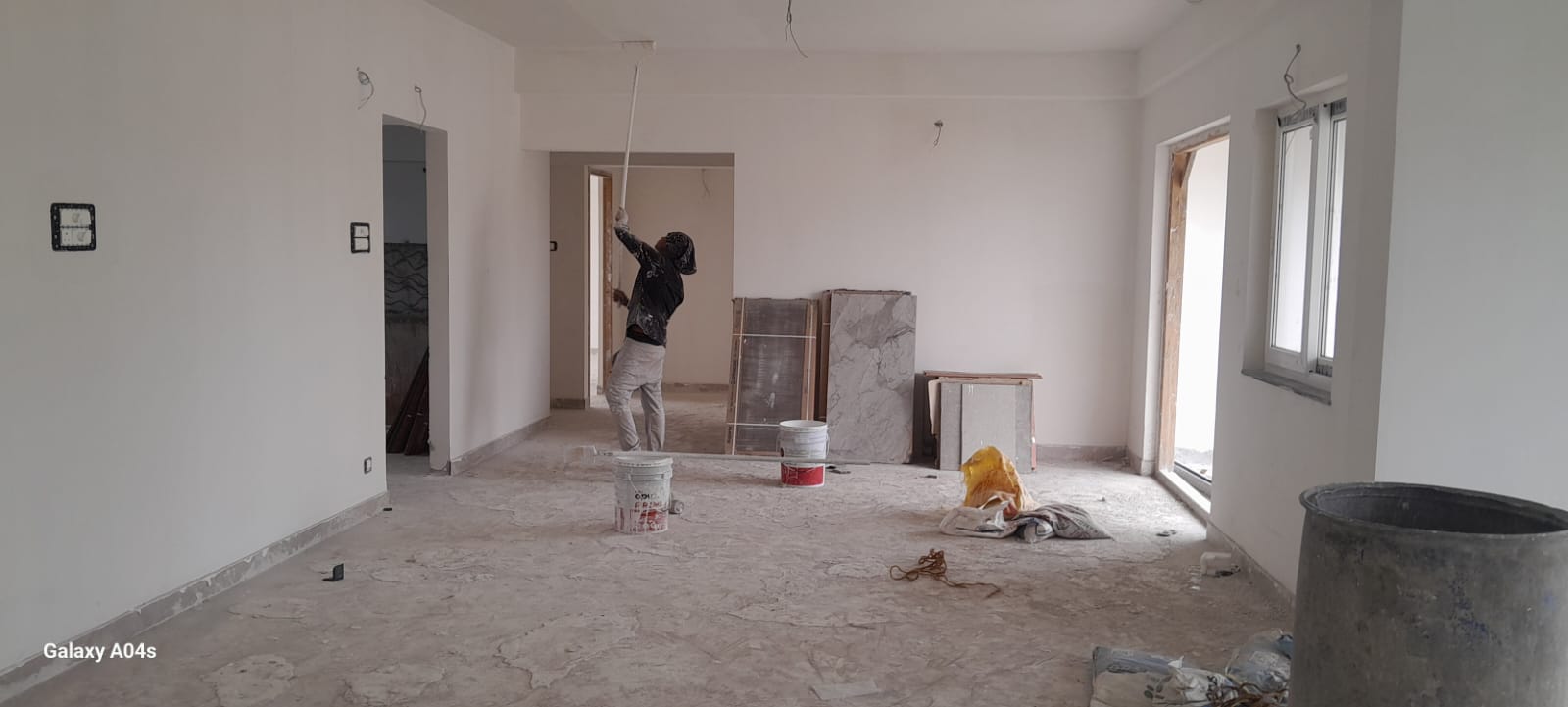

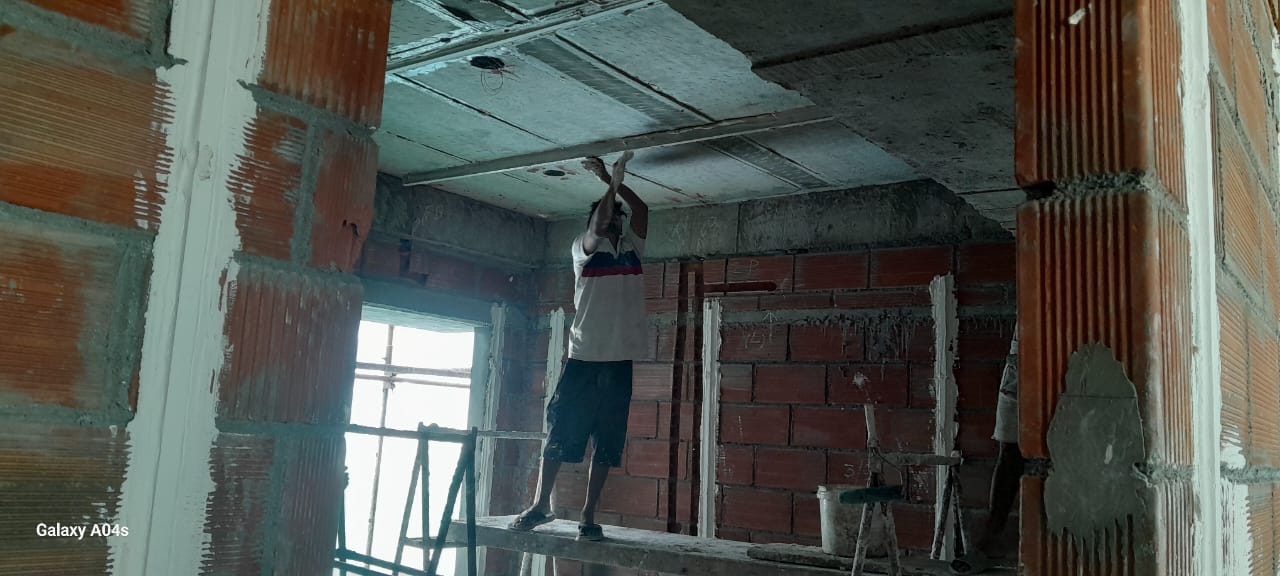

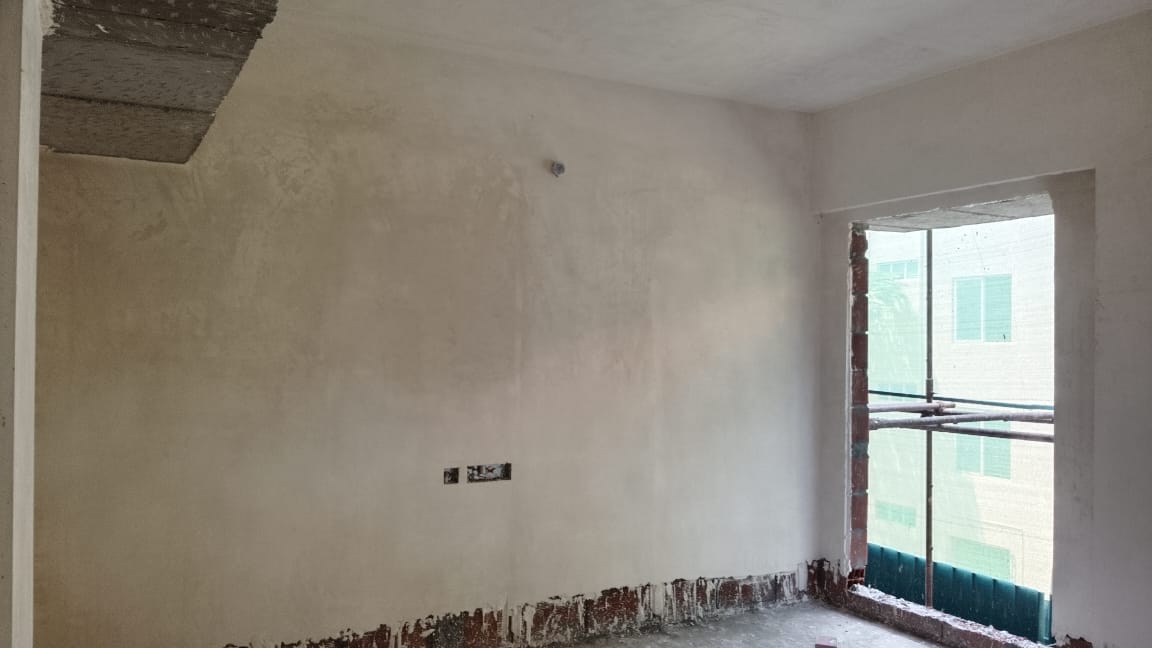

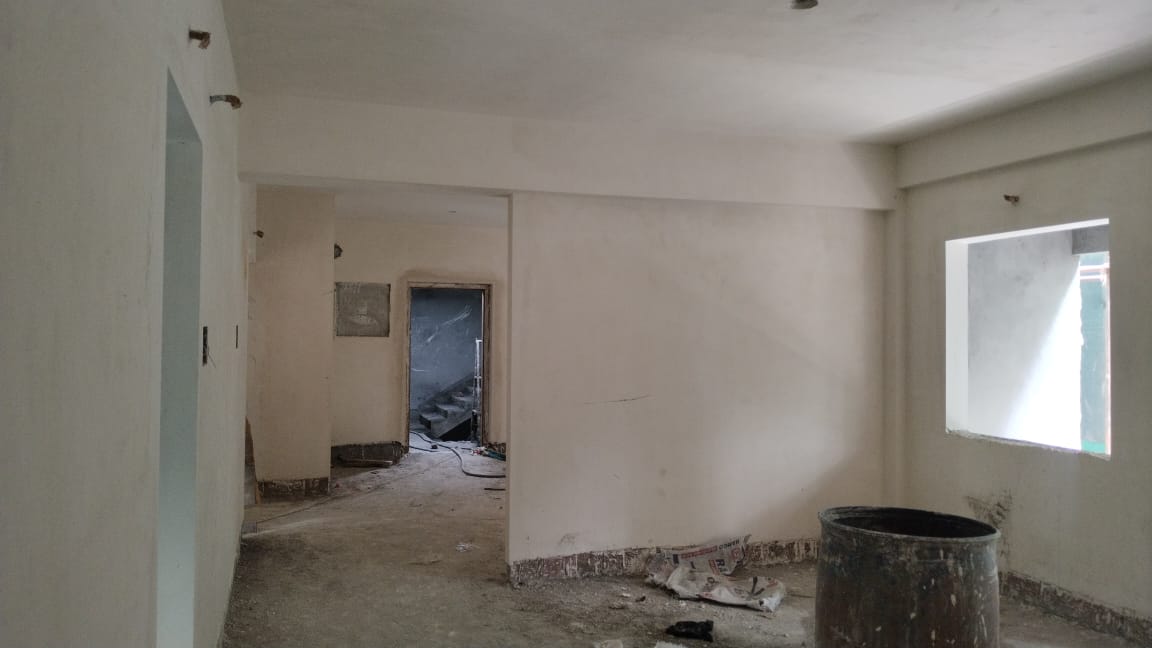

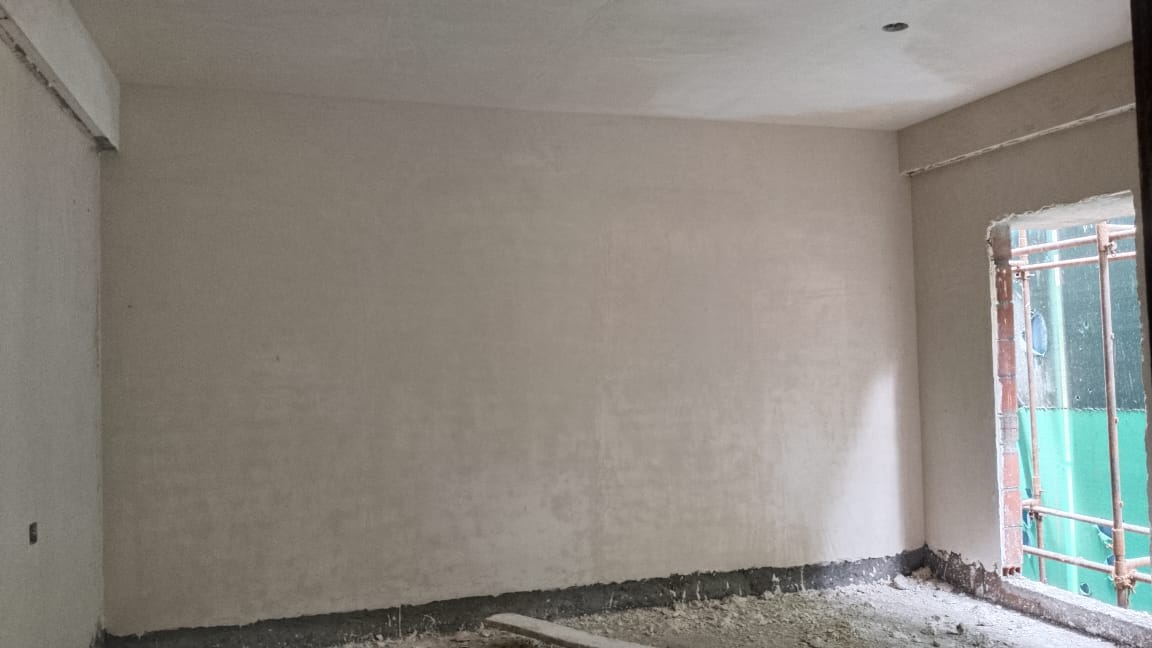

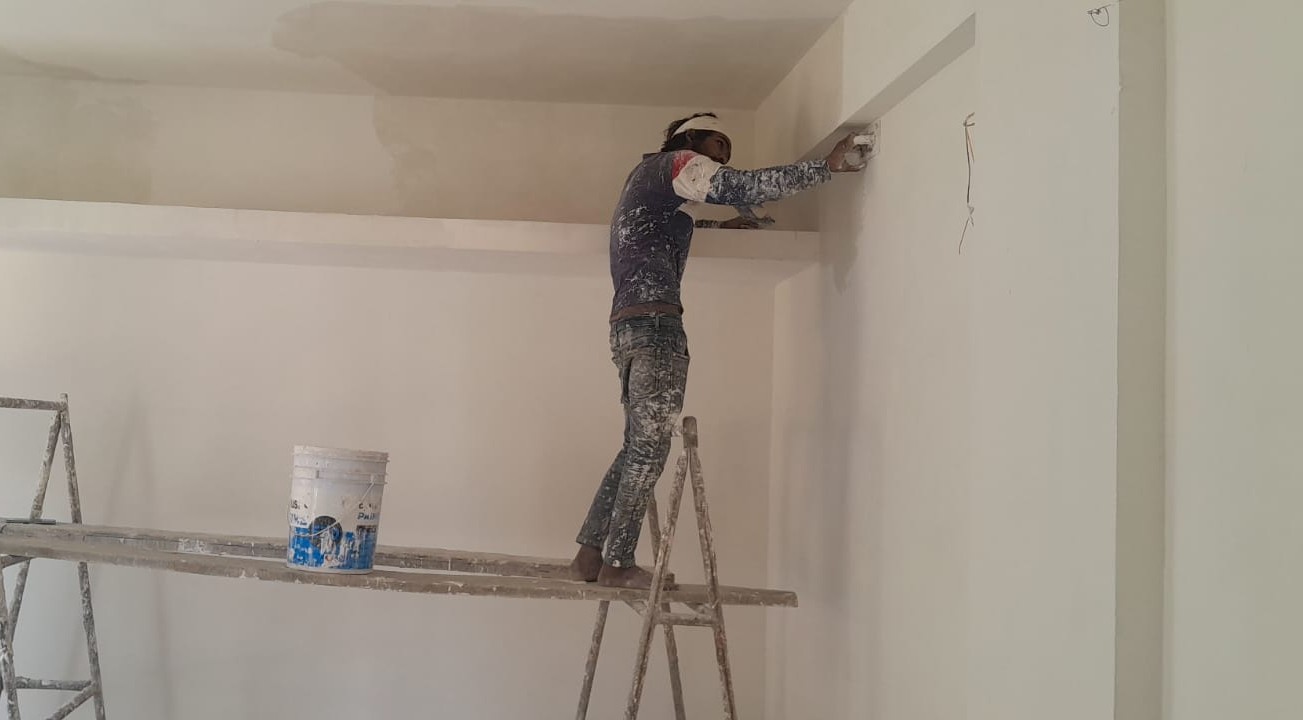

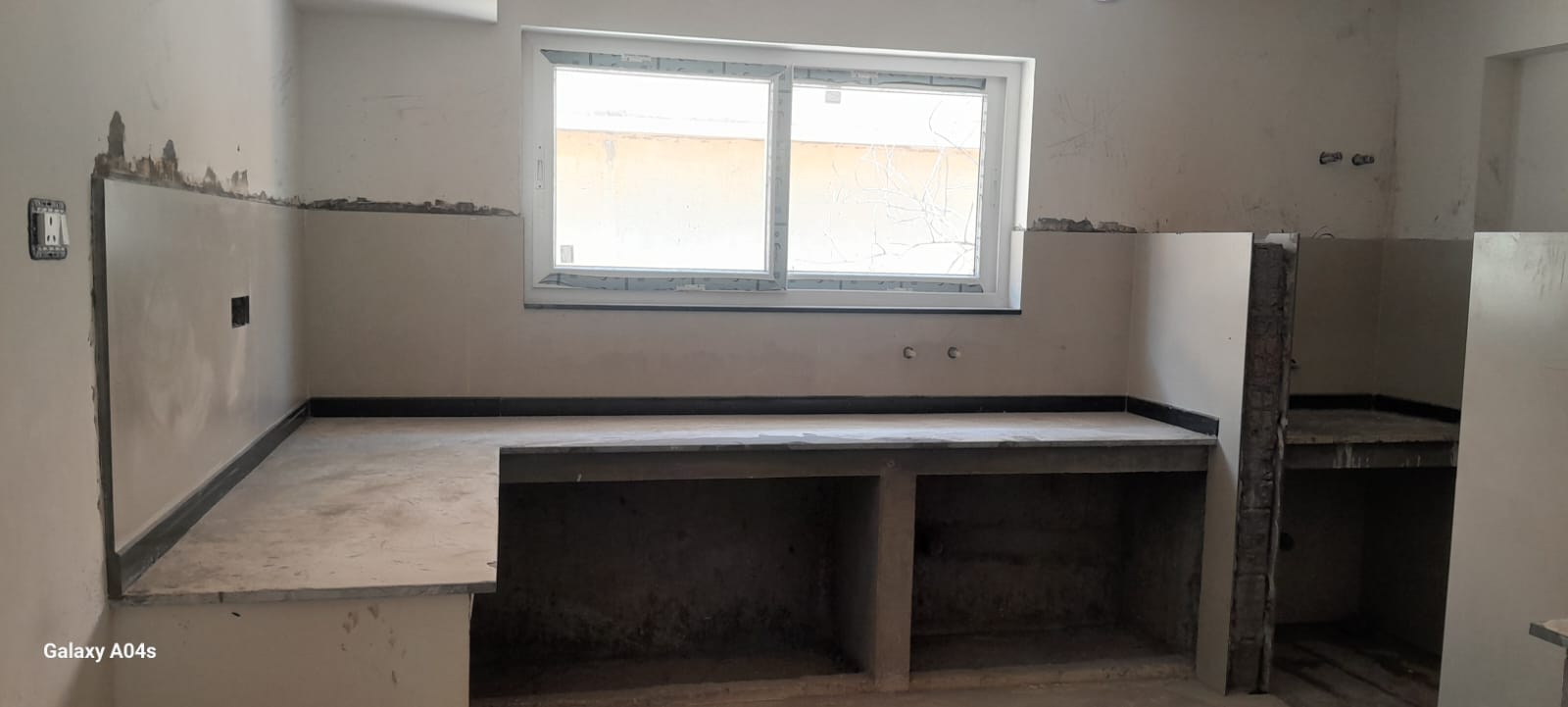

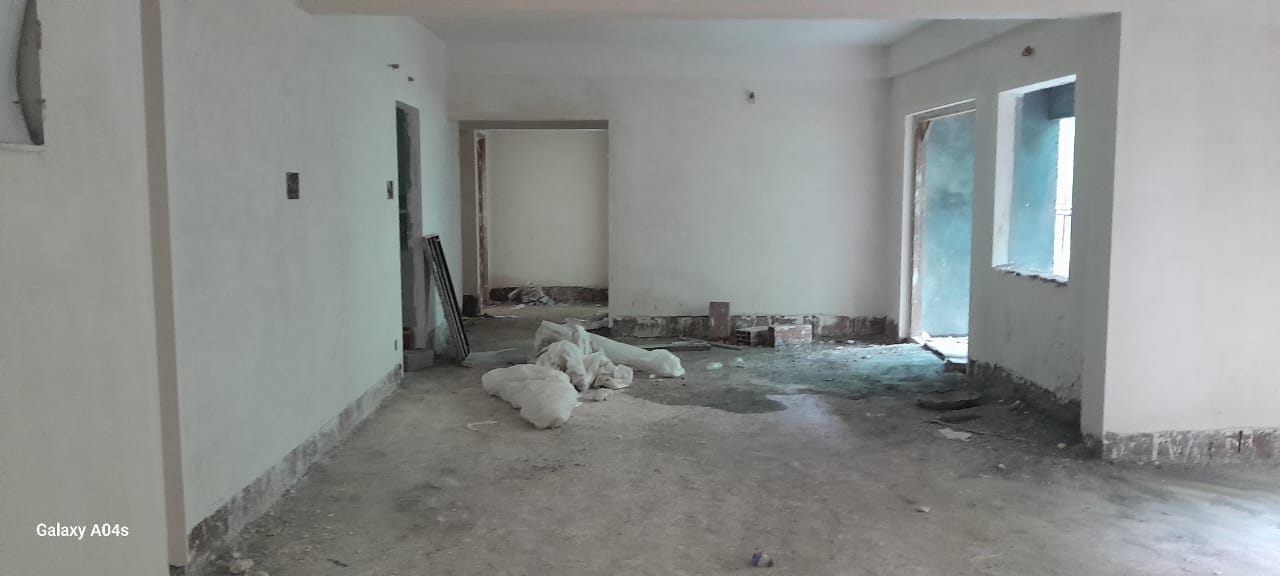

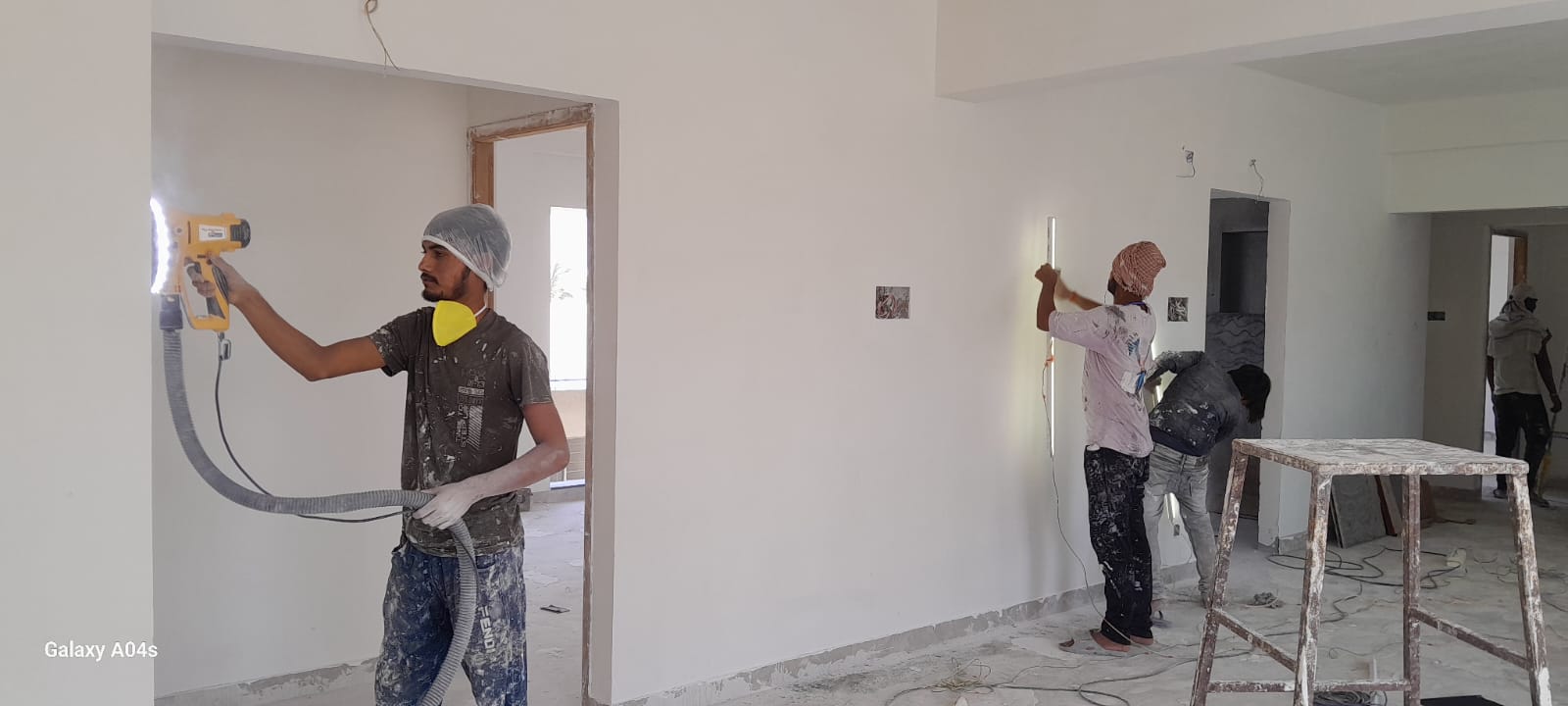

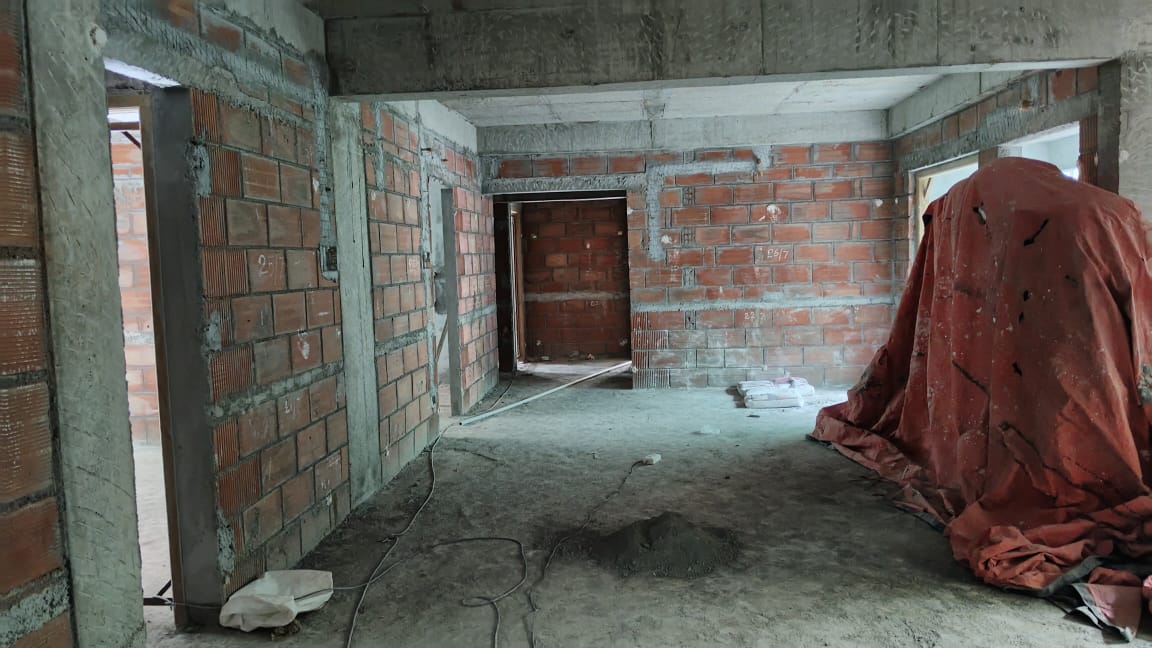

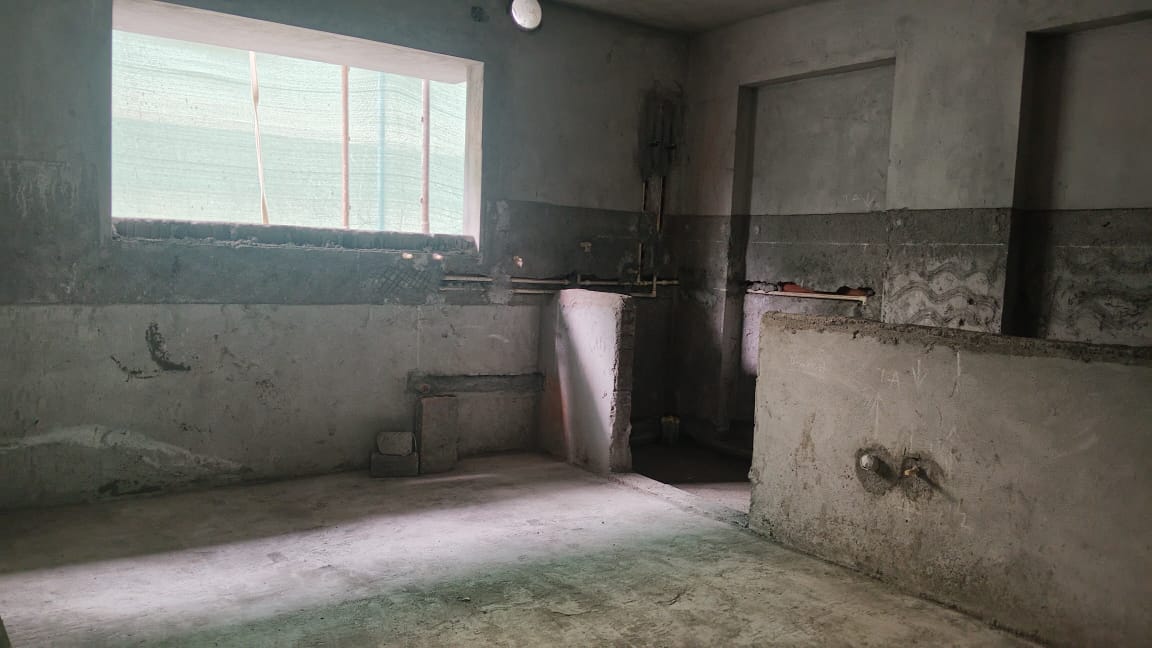

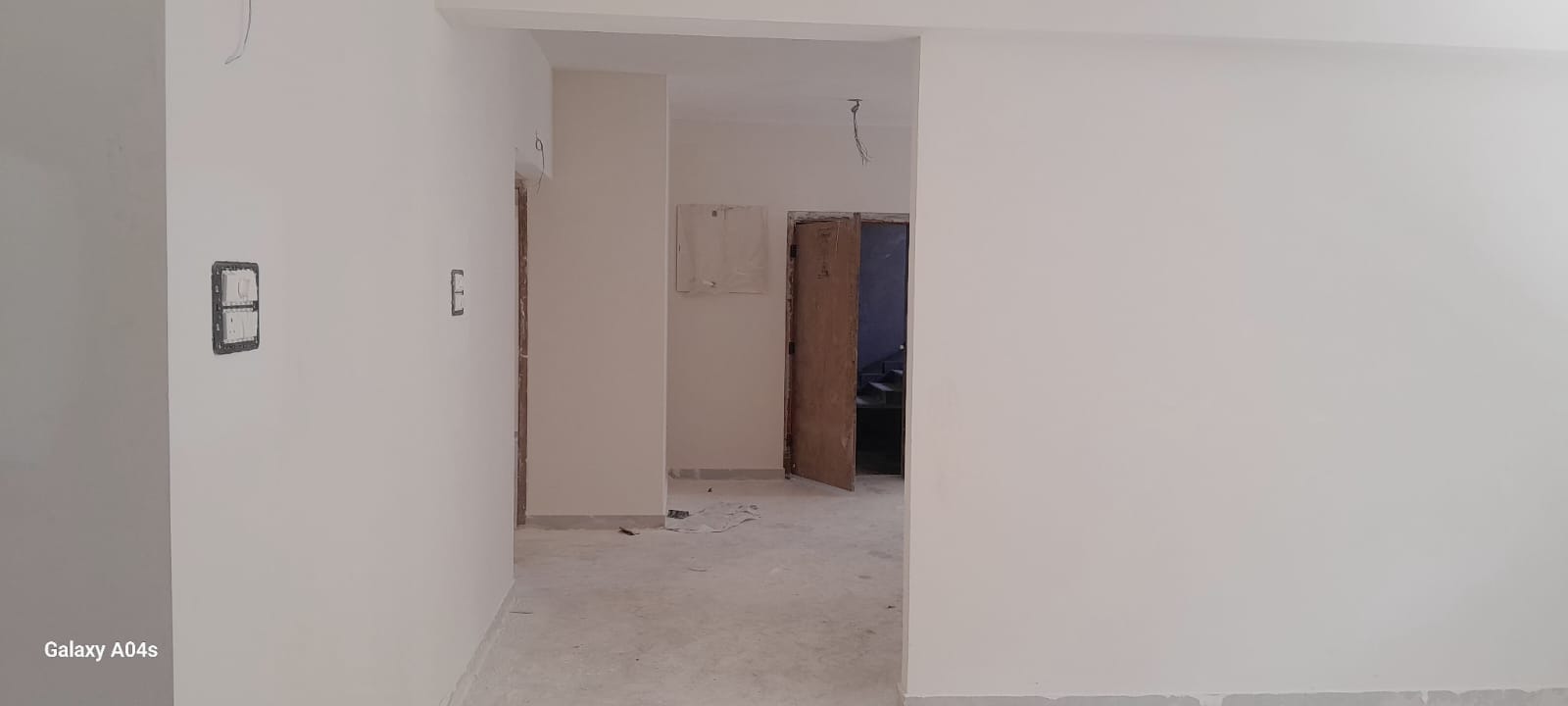

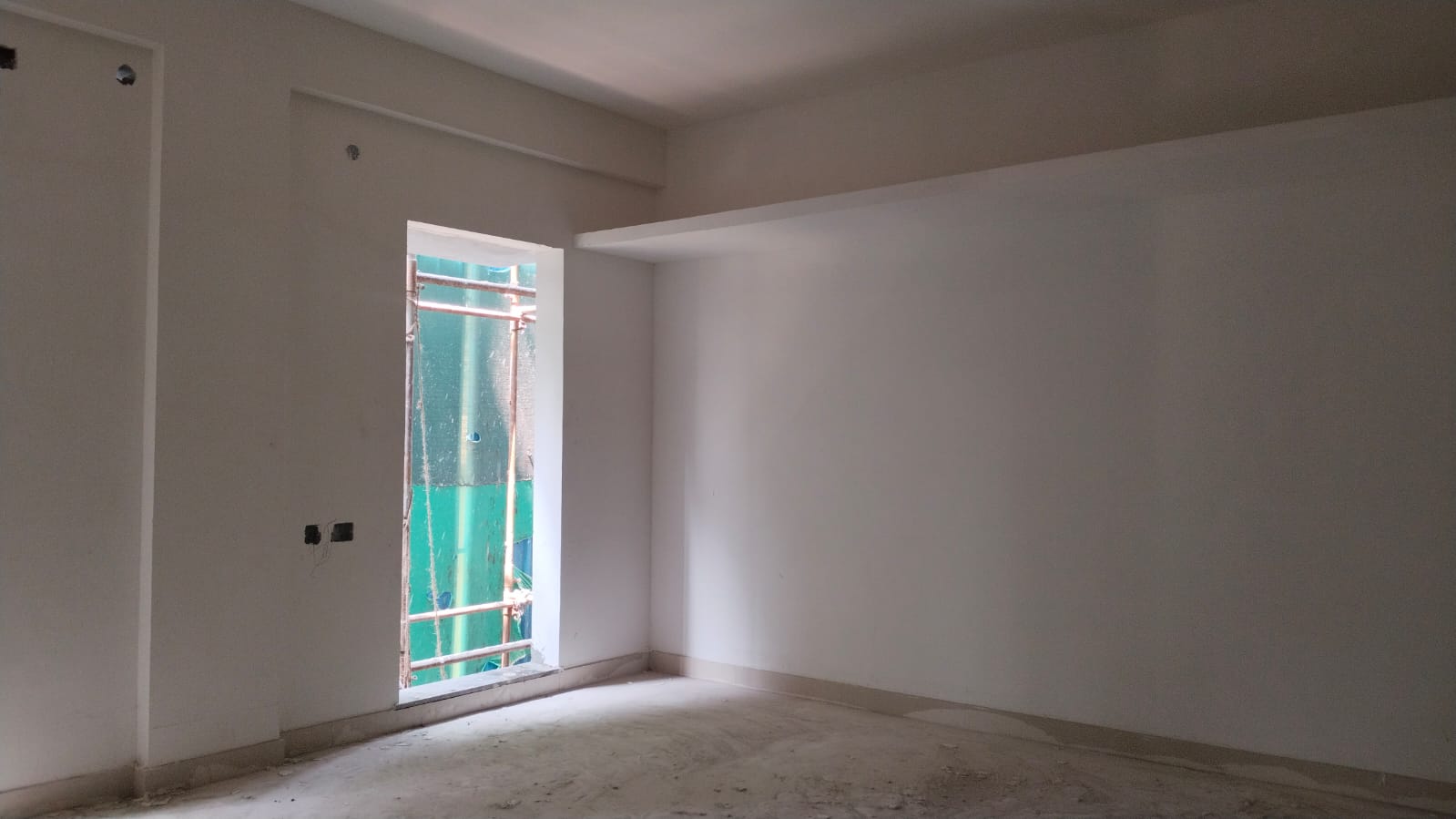

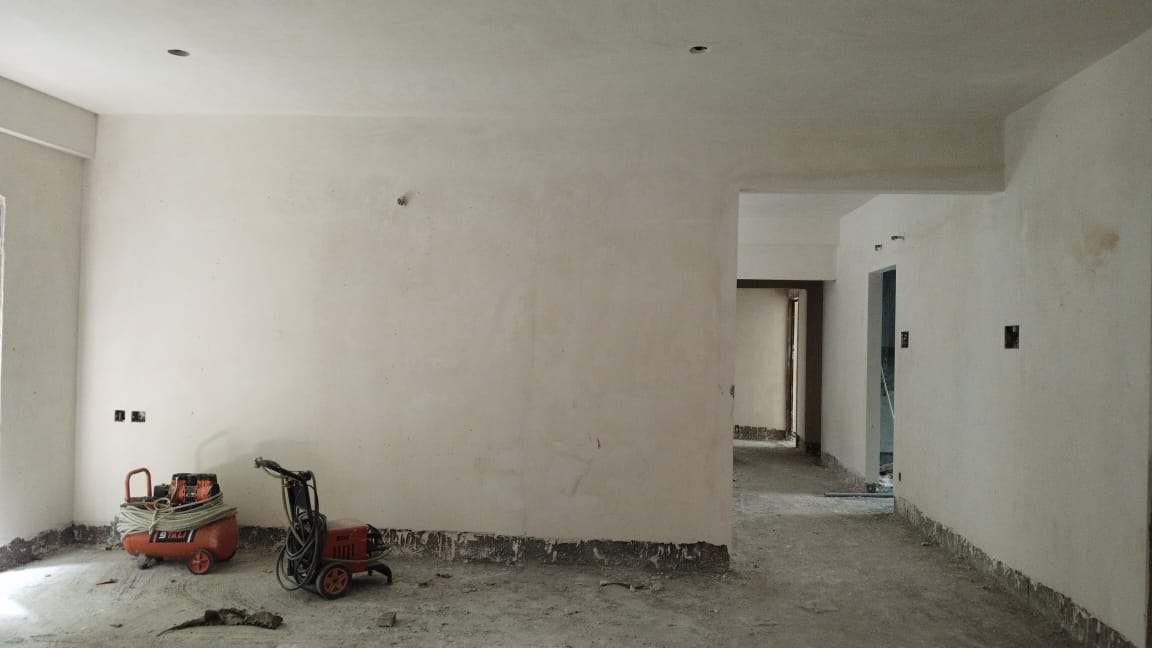

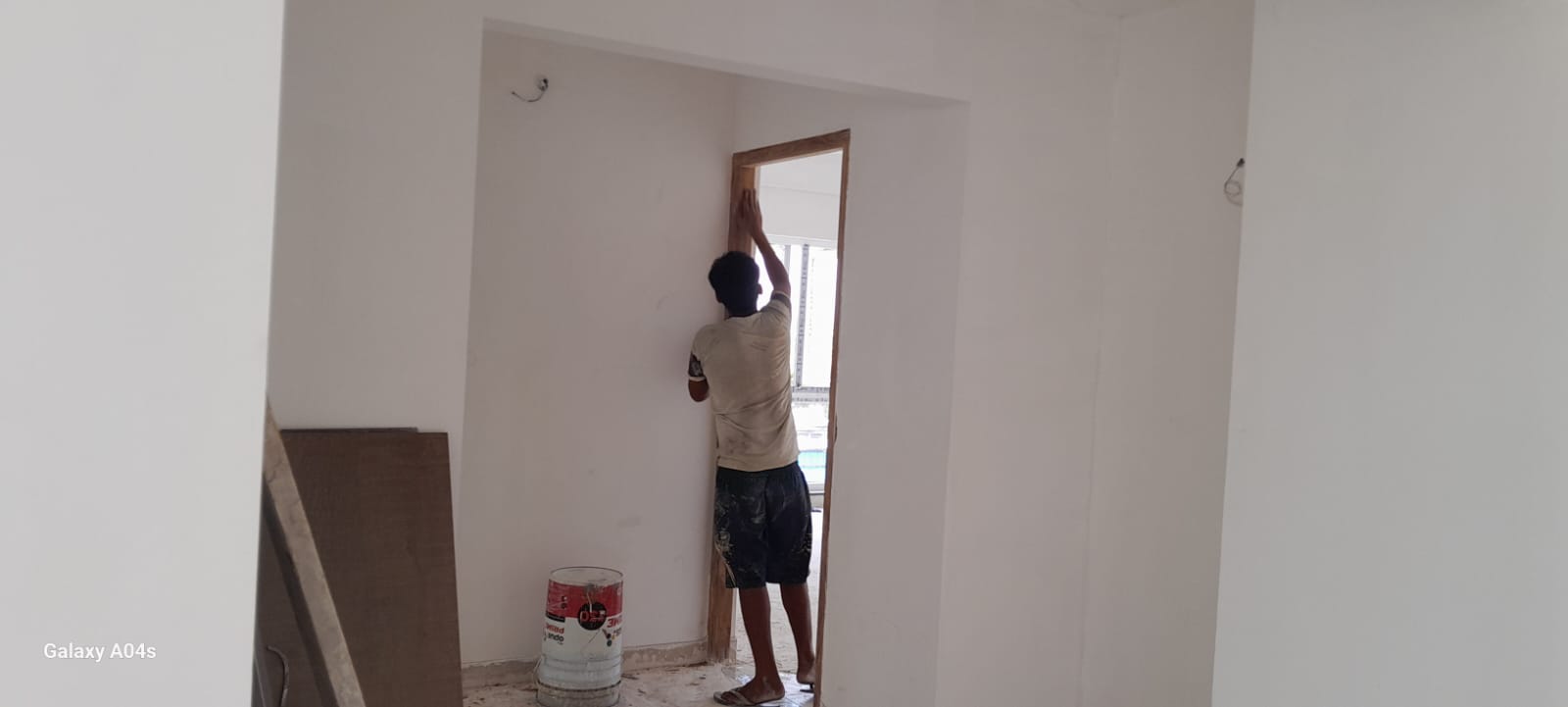

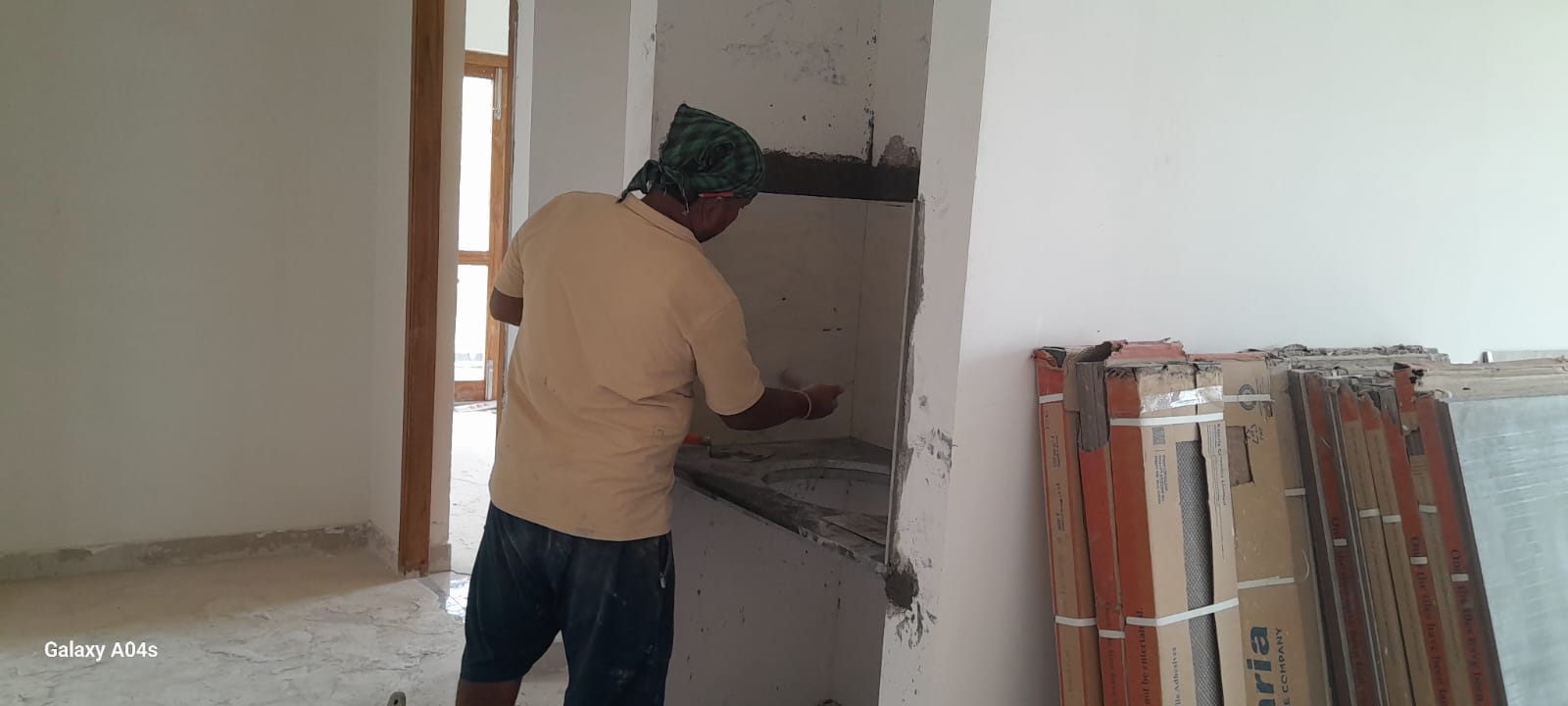

  • Inner putty work is in progress. (up to 4th floor completed,5th floor 50% completed)

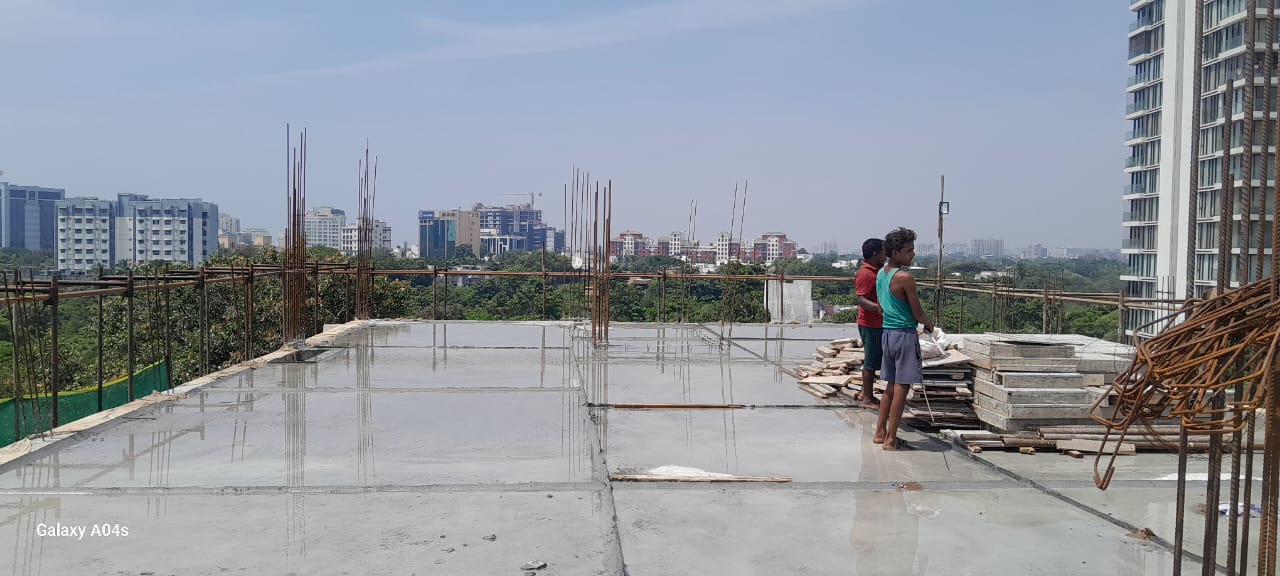

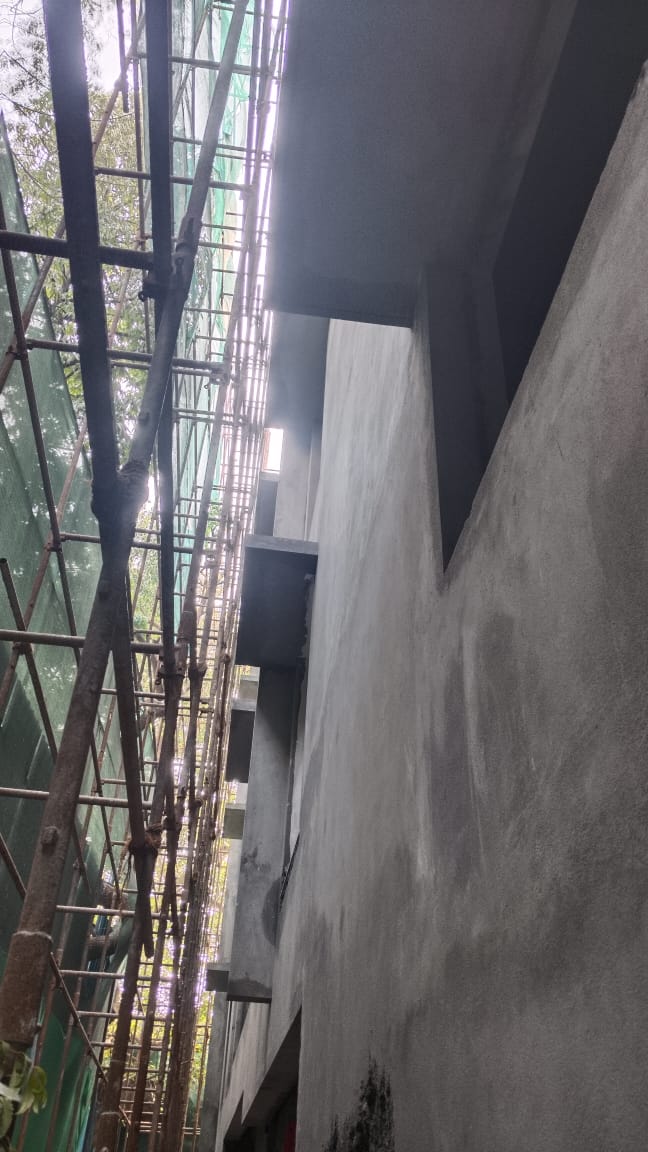

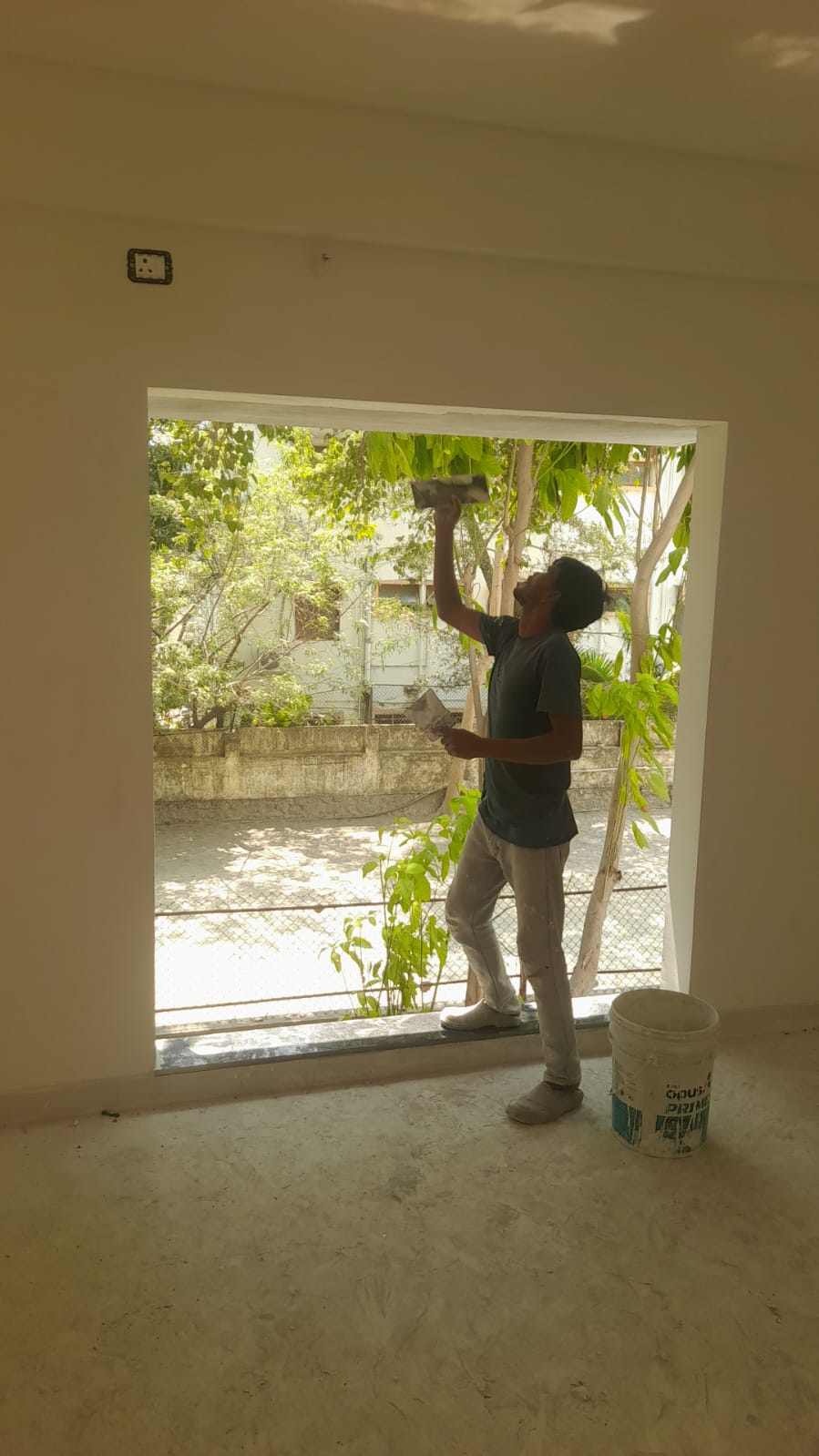

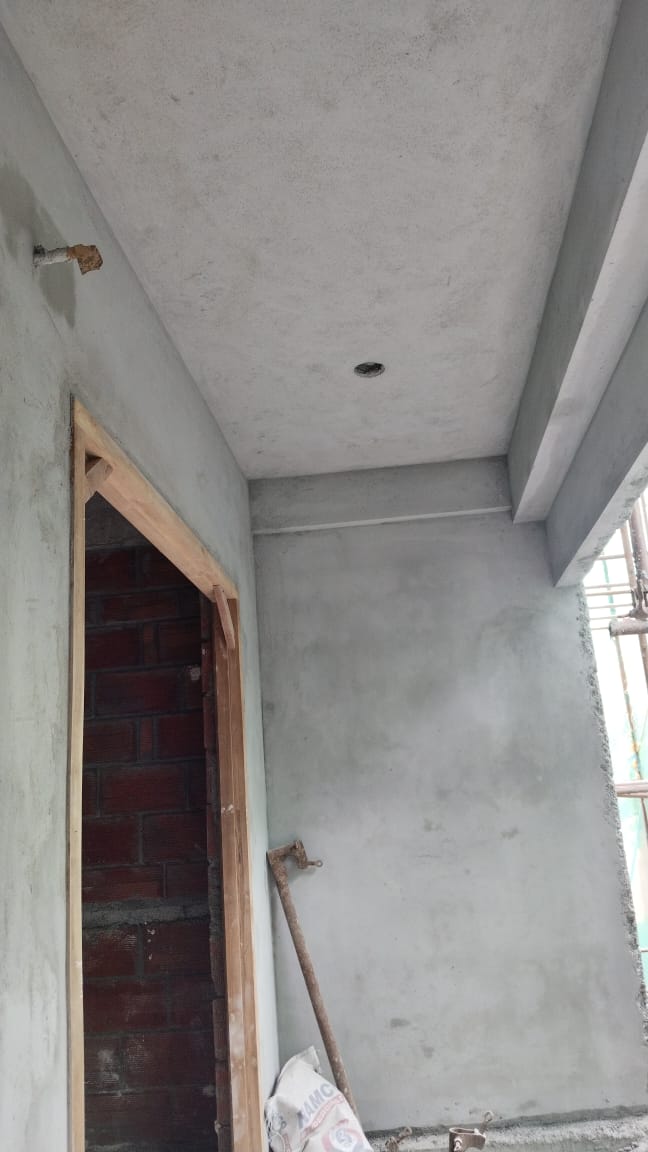

  • 5th Floor inner primer work is in progress. (Up to 4th floor completed)

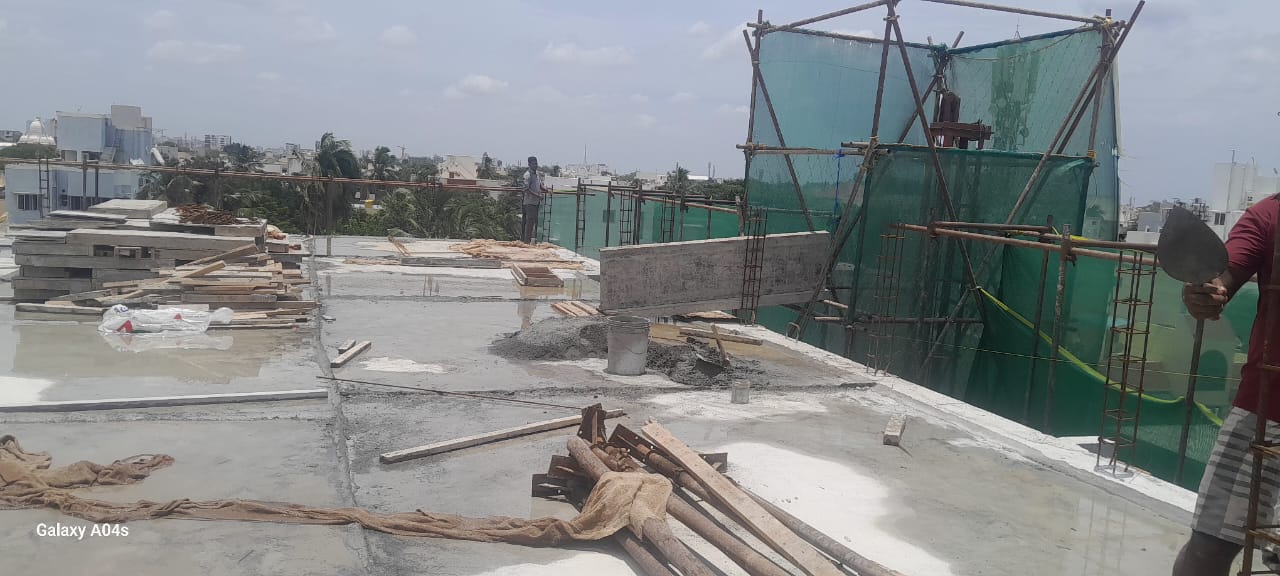

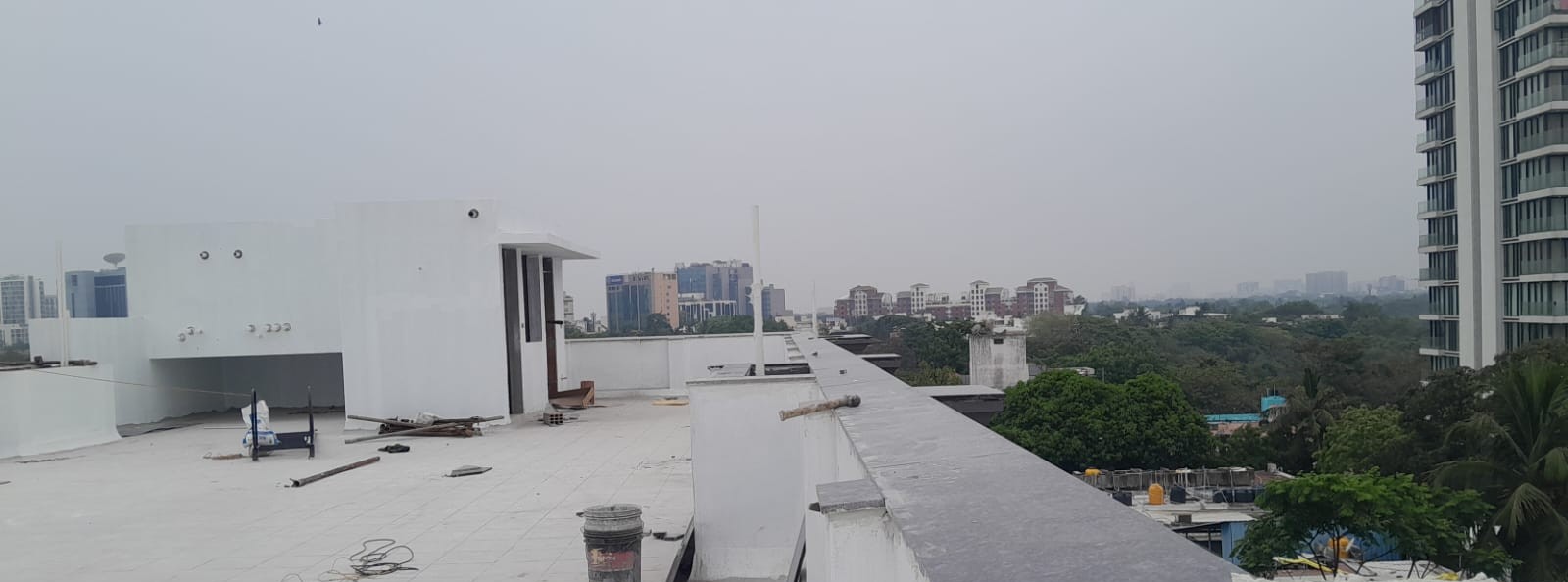

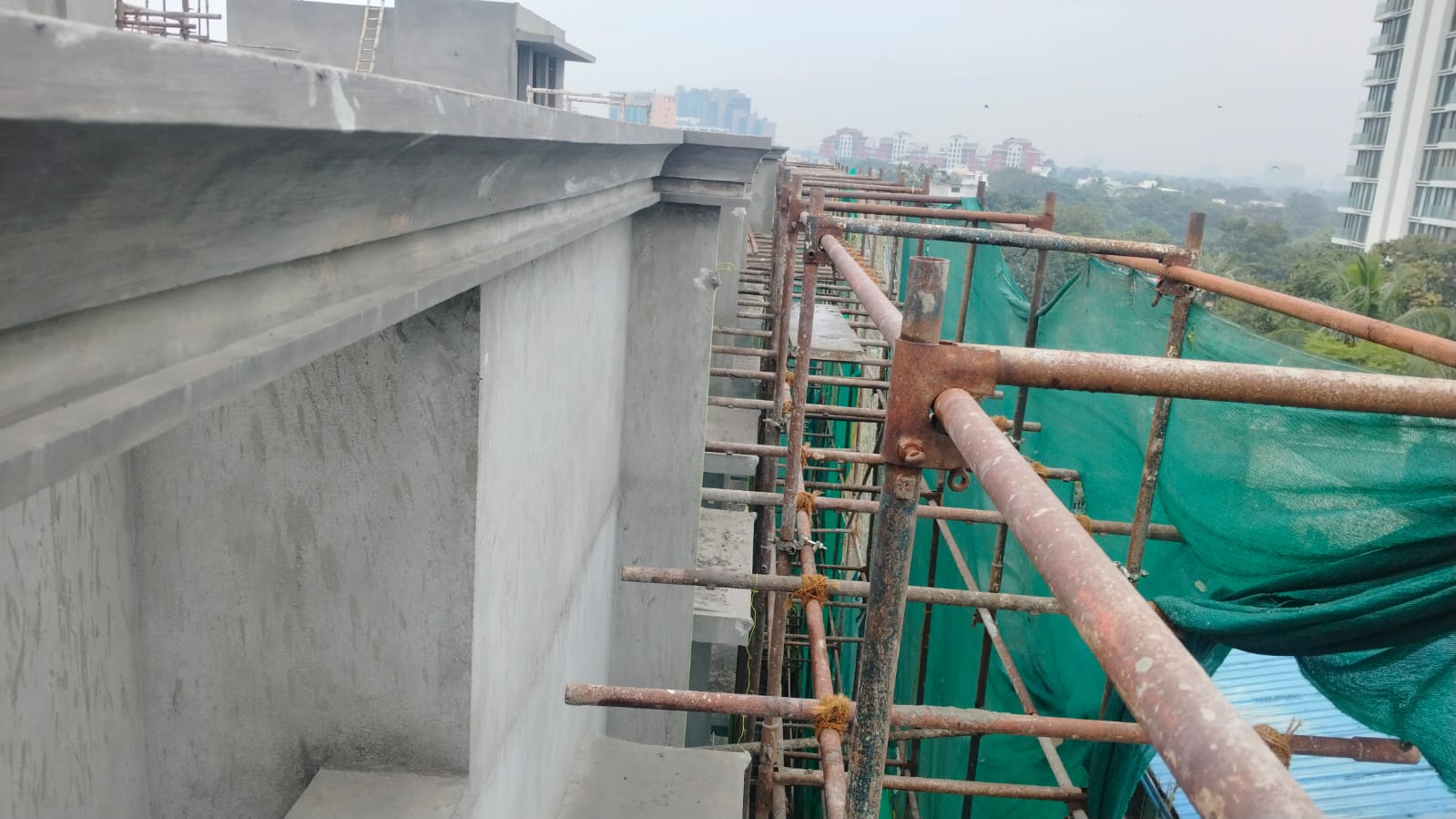

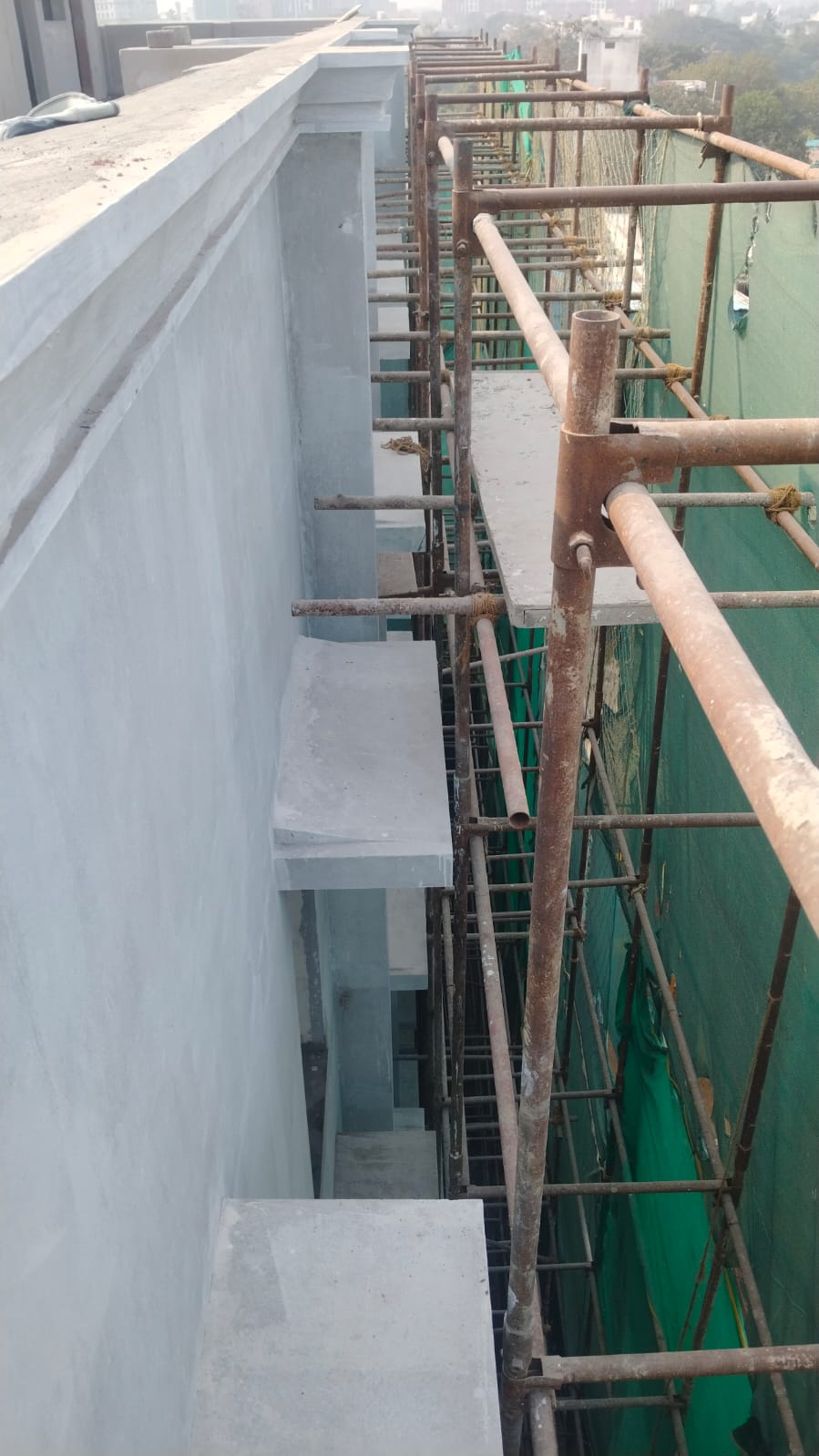

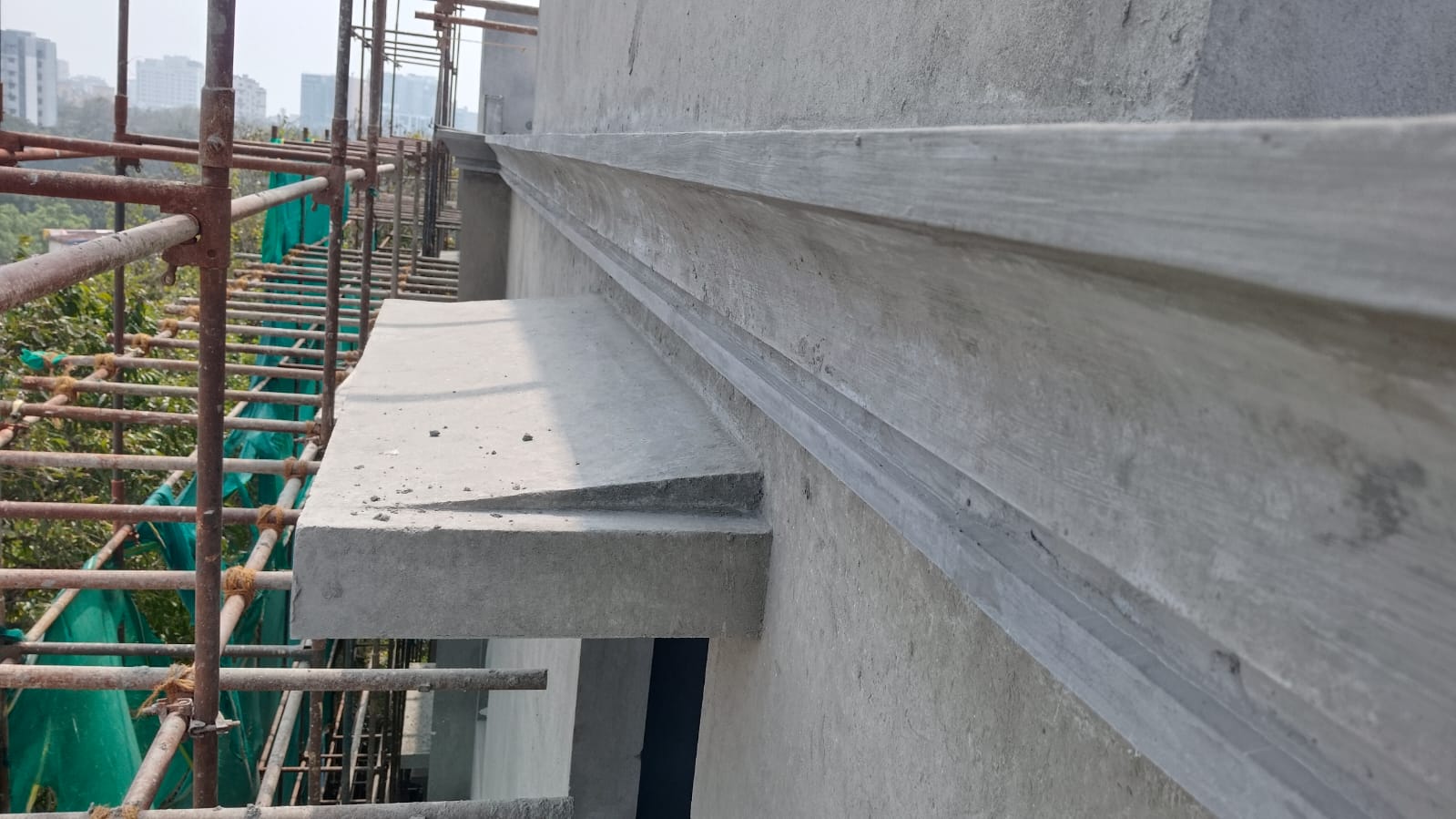

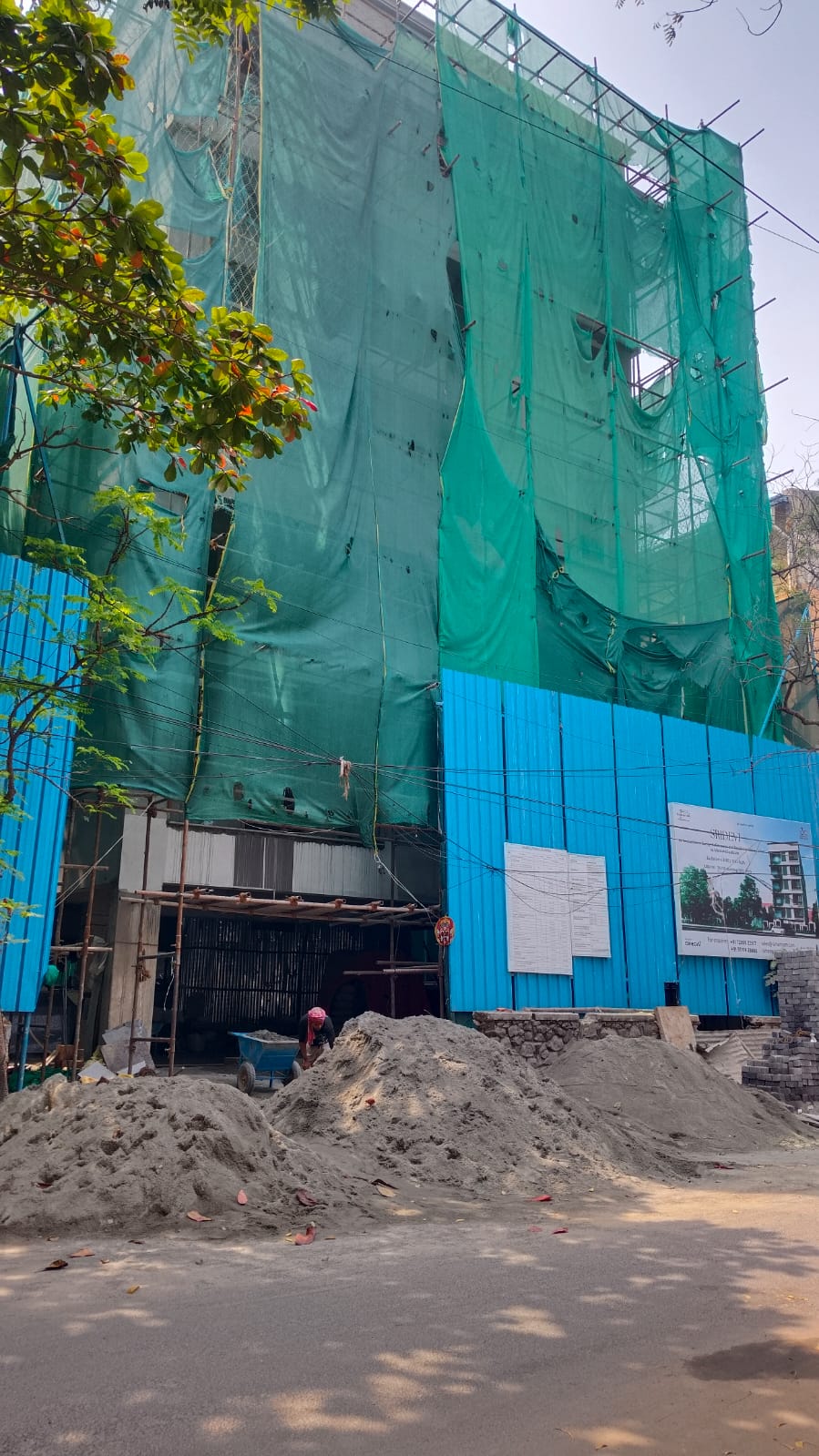

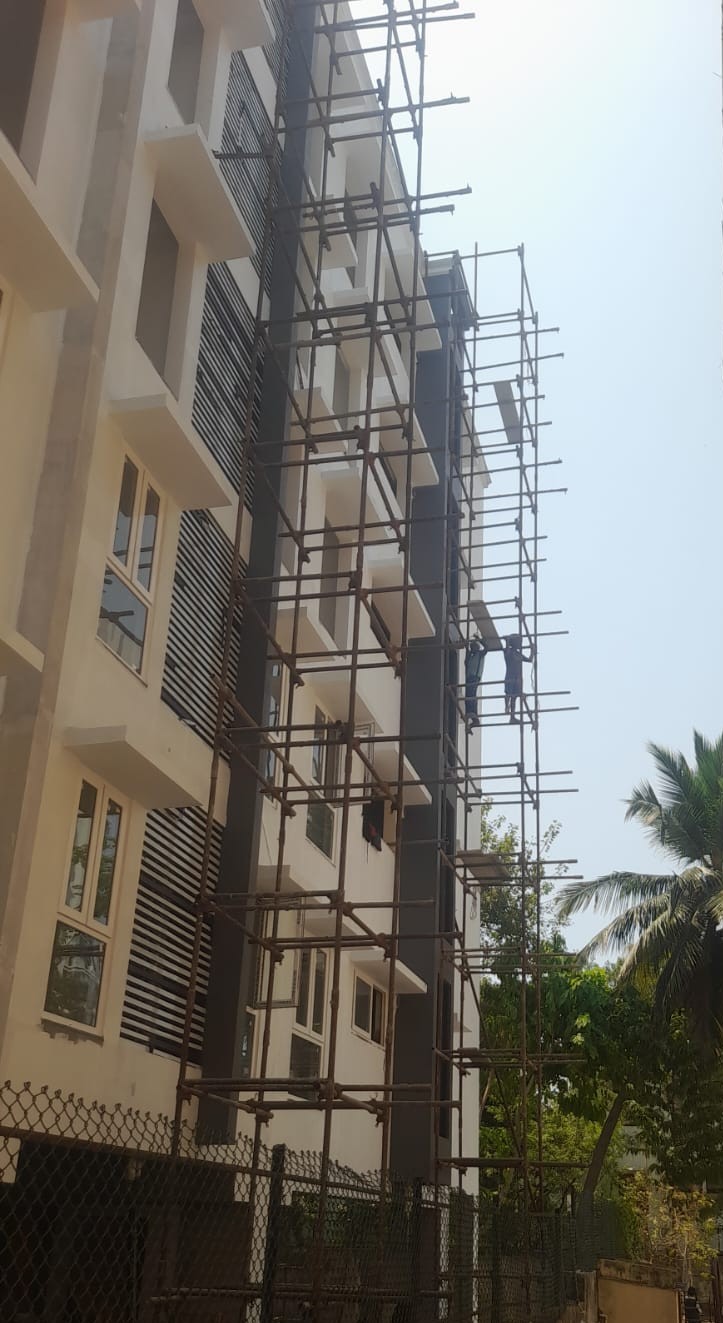

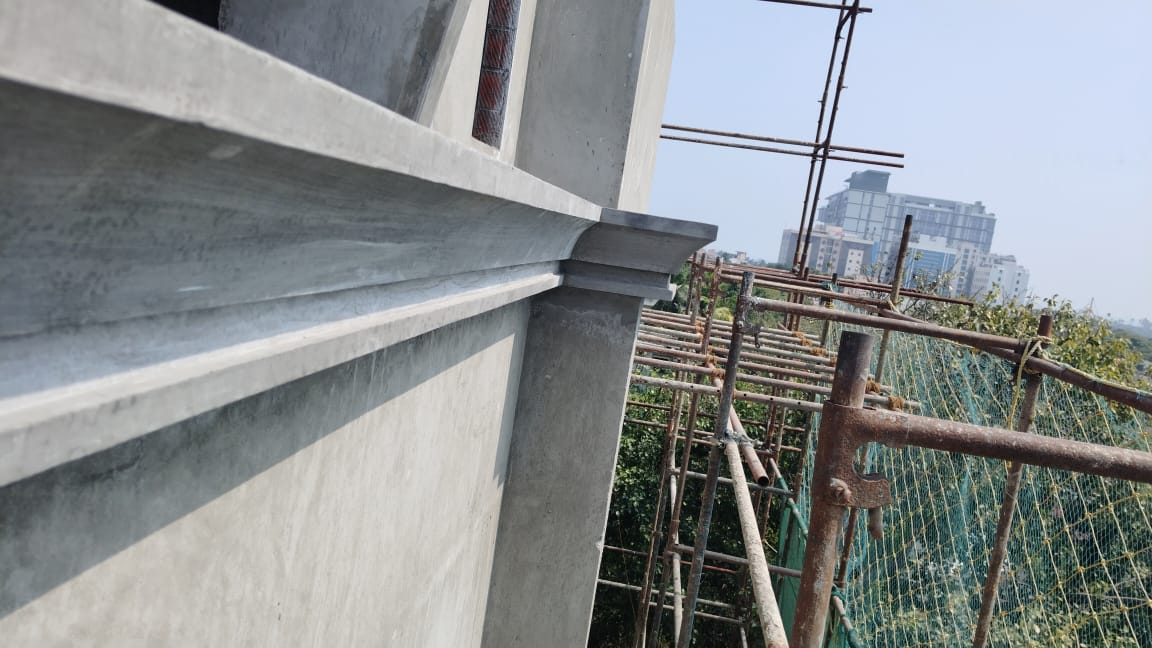

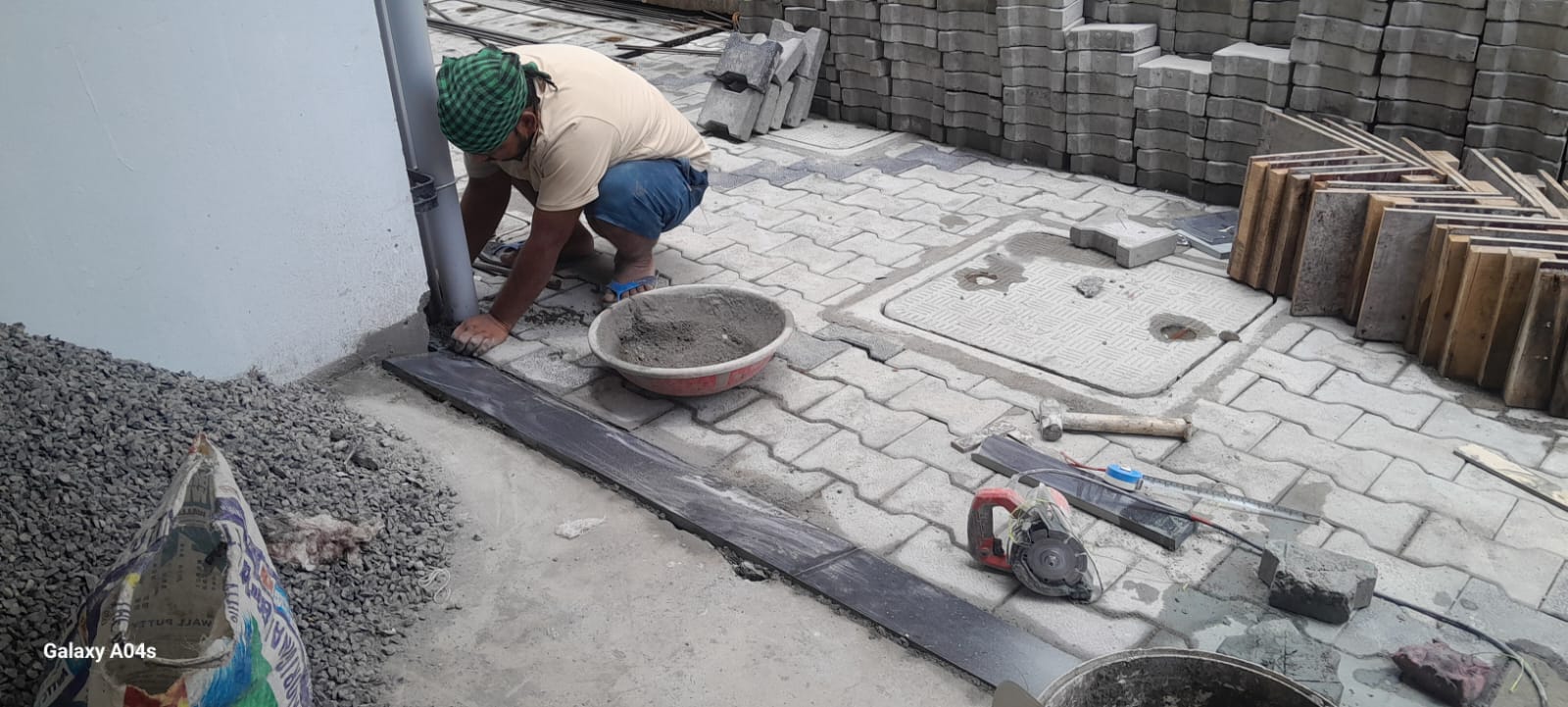

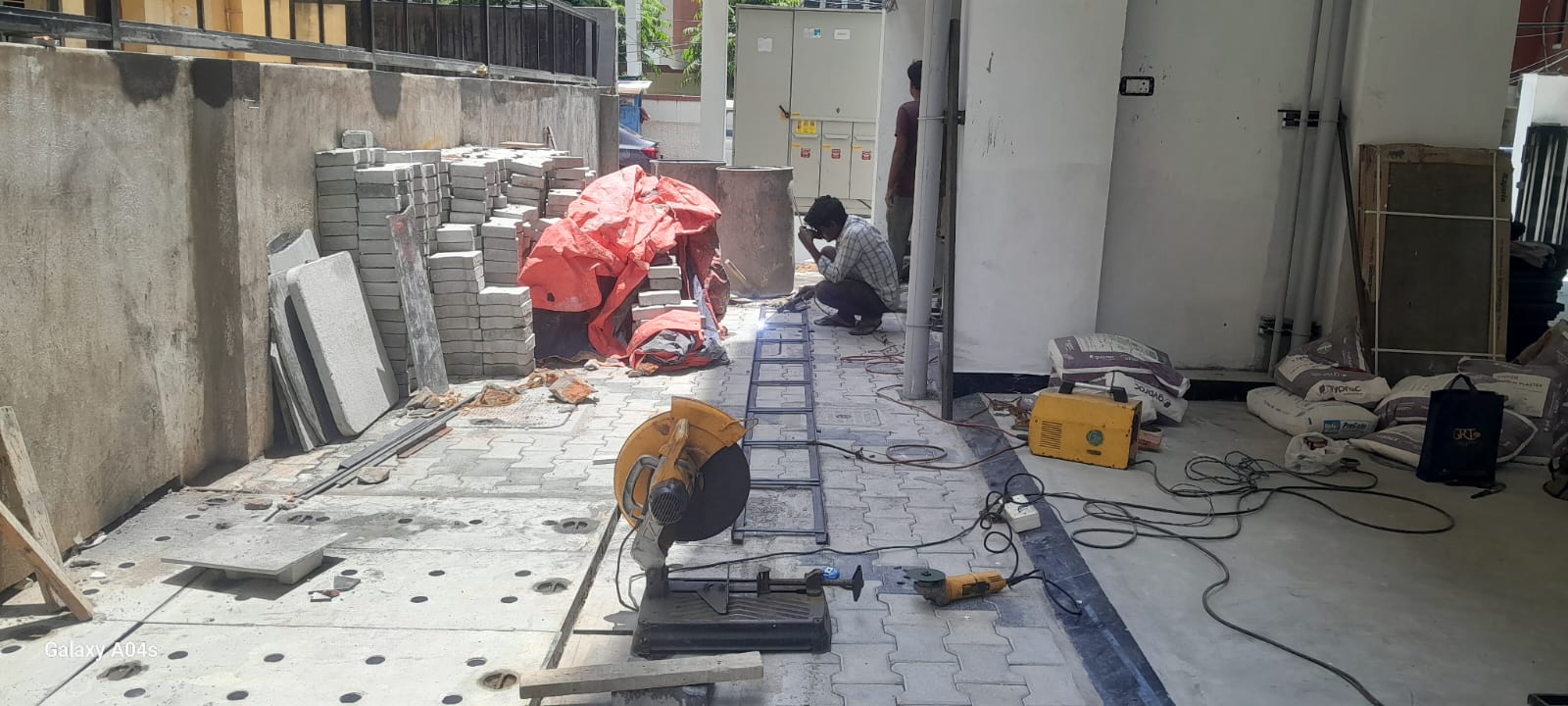

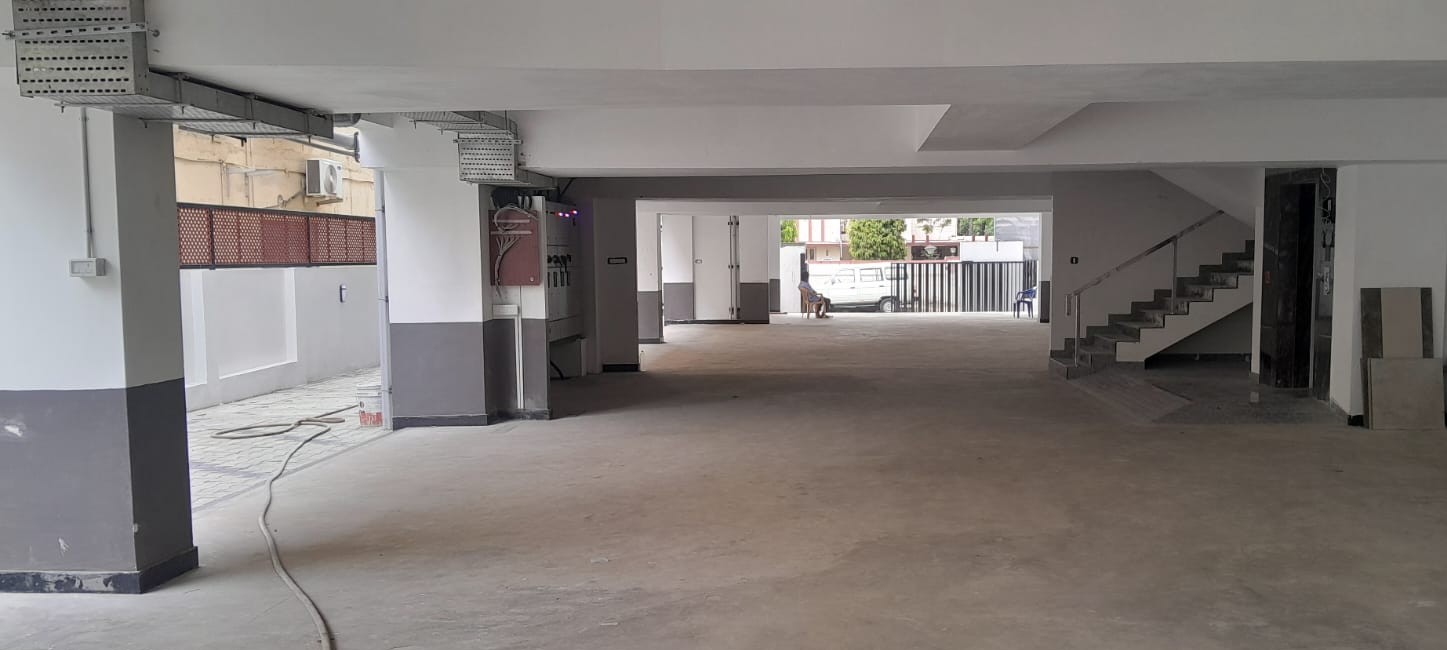

  • Paving block work is in progress.(75% completed)

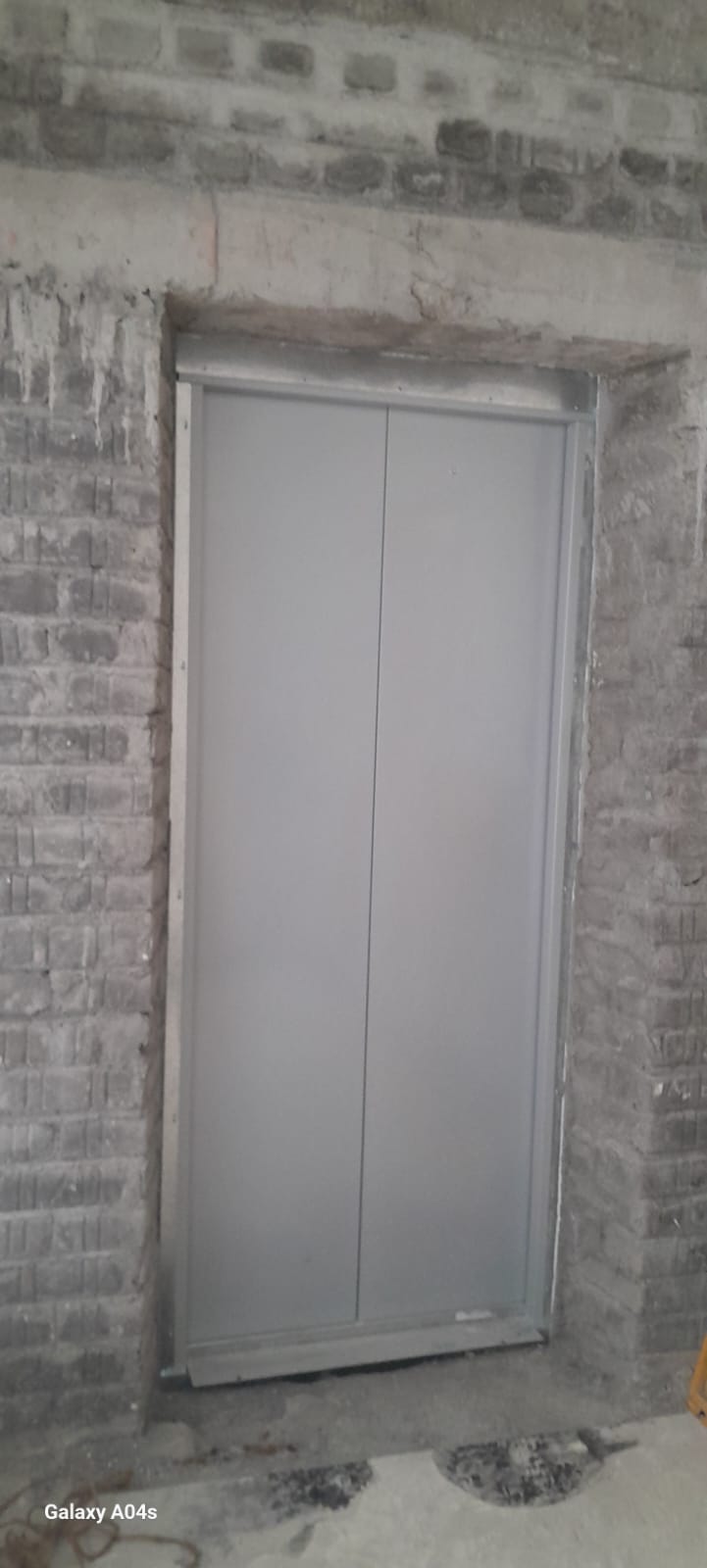

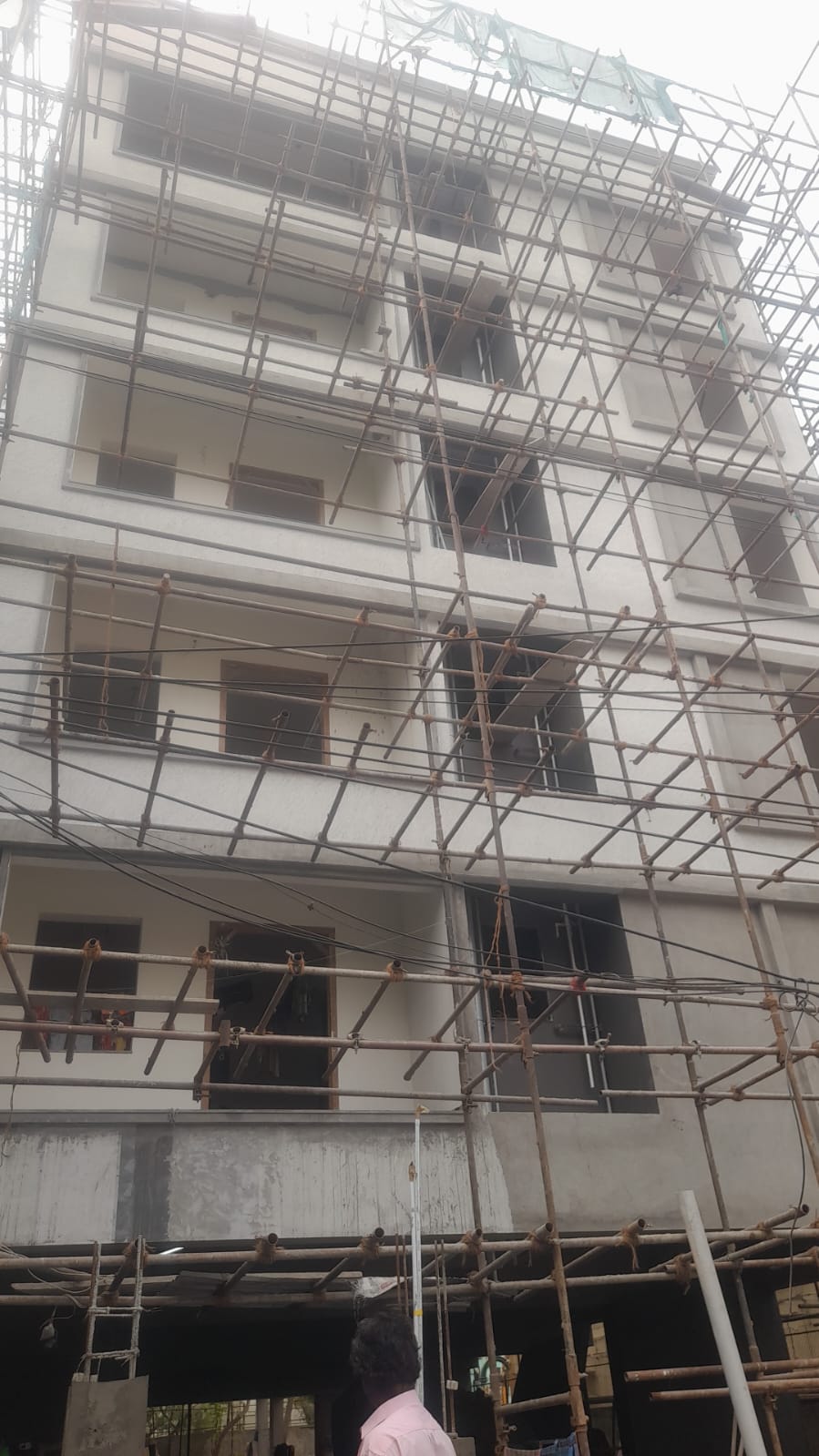

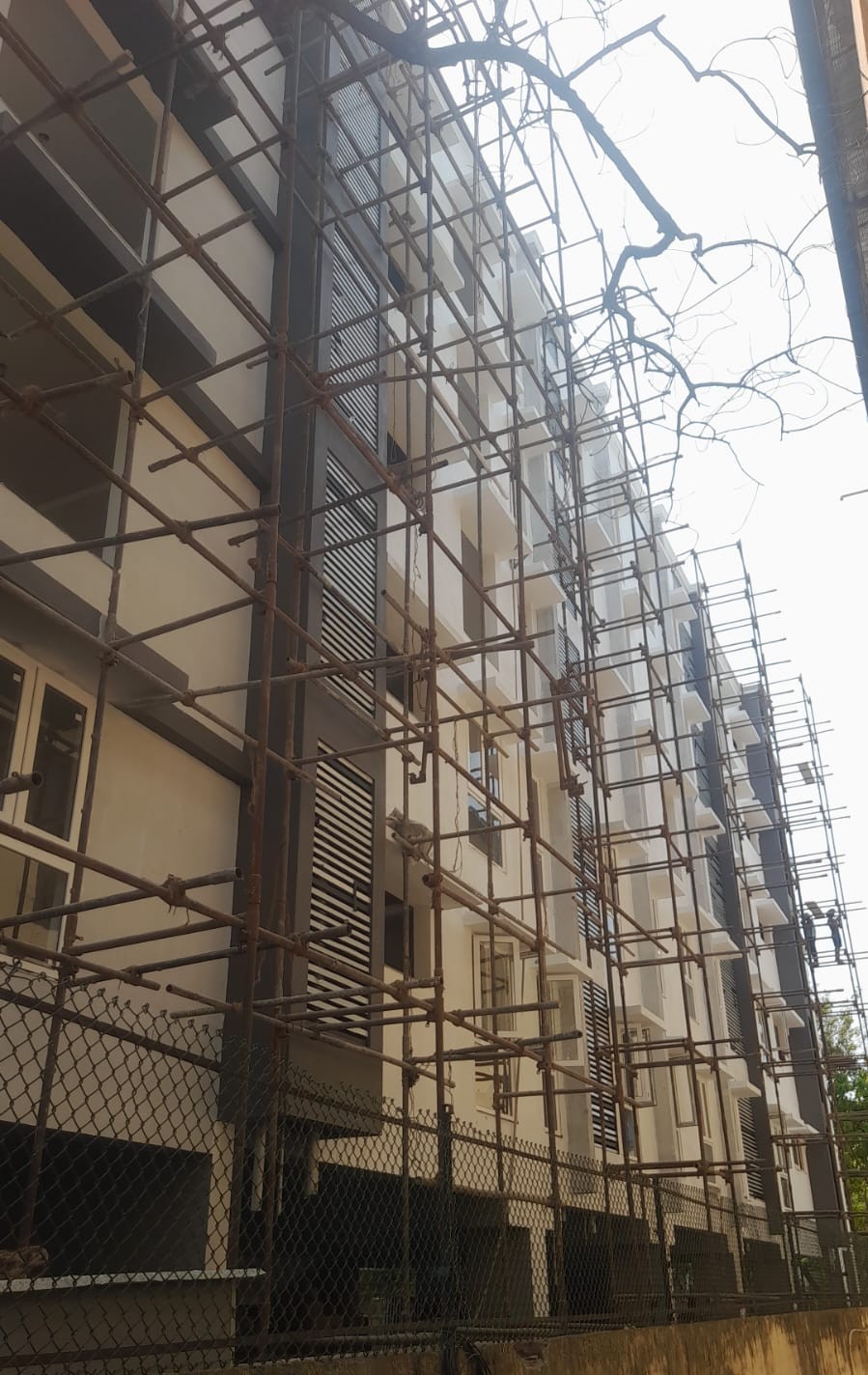

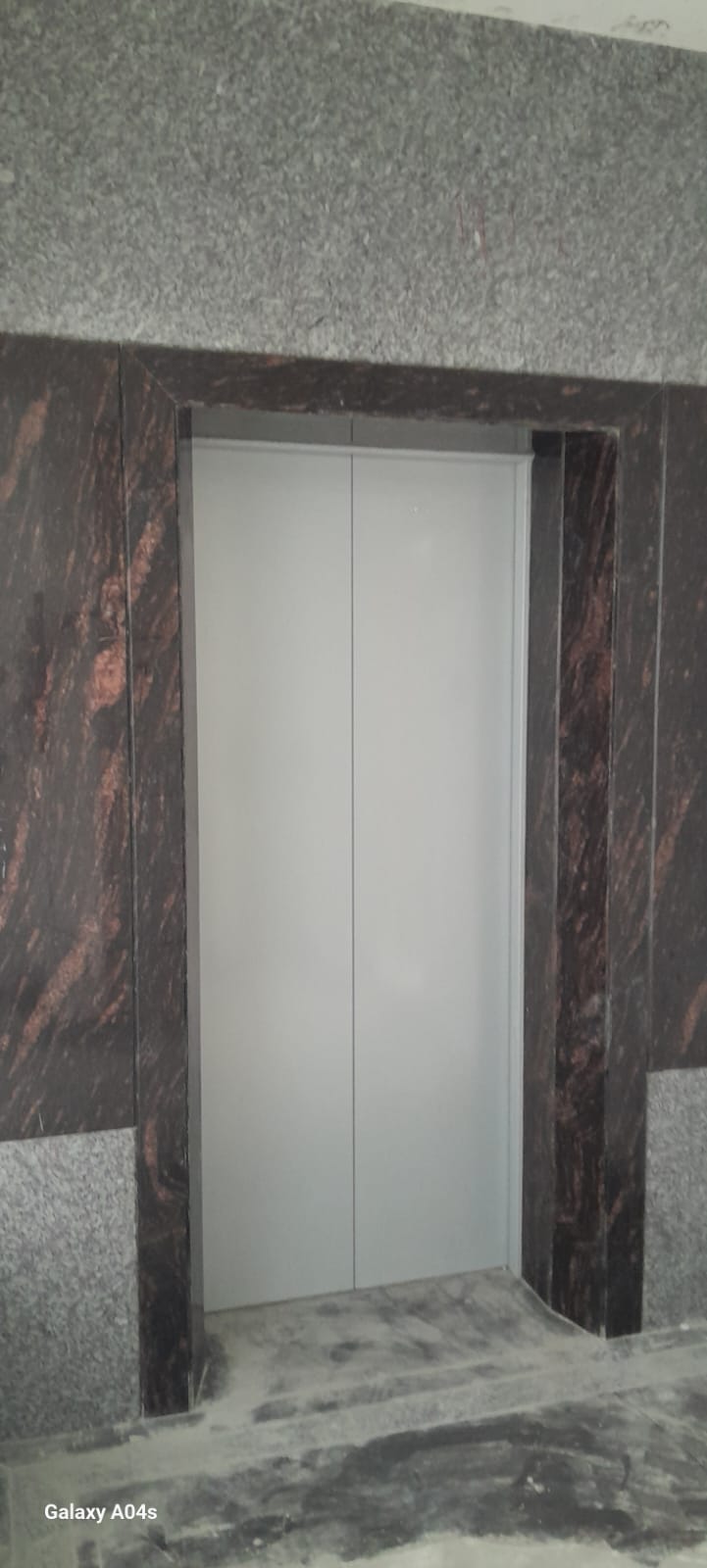

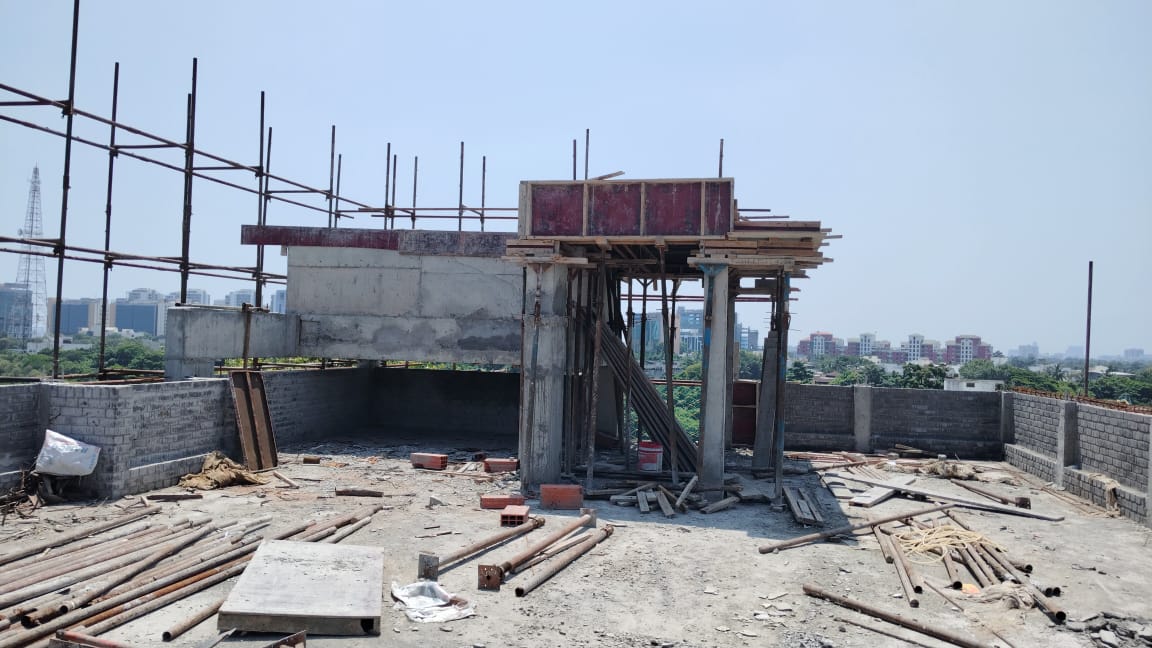

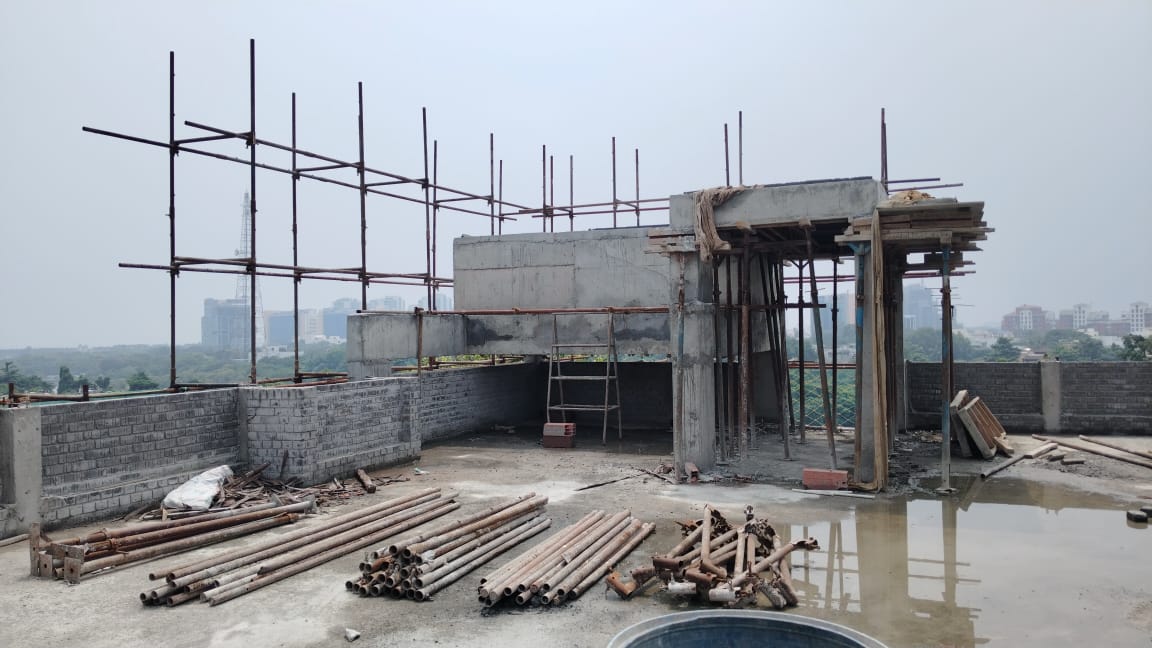

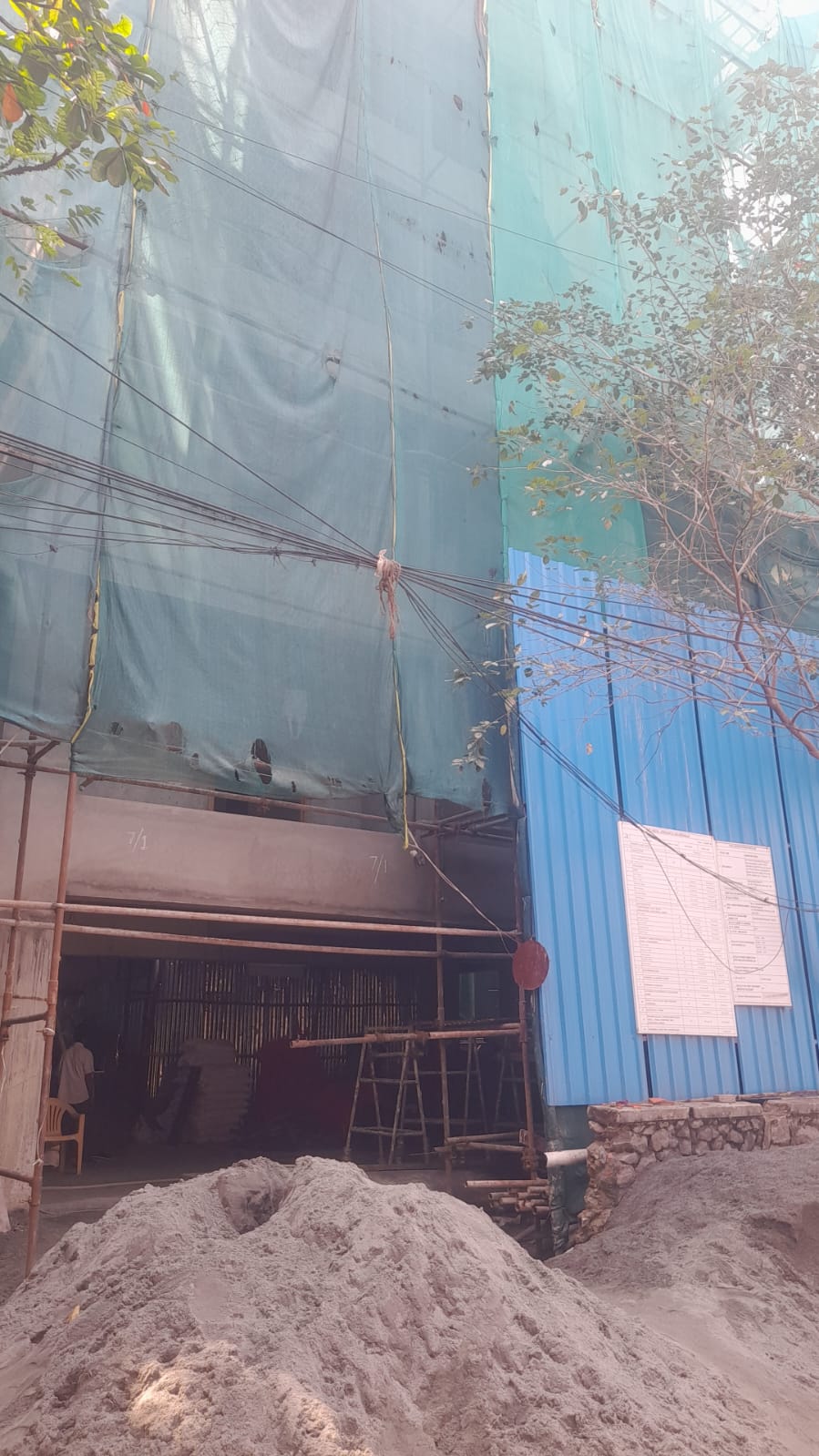

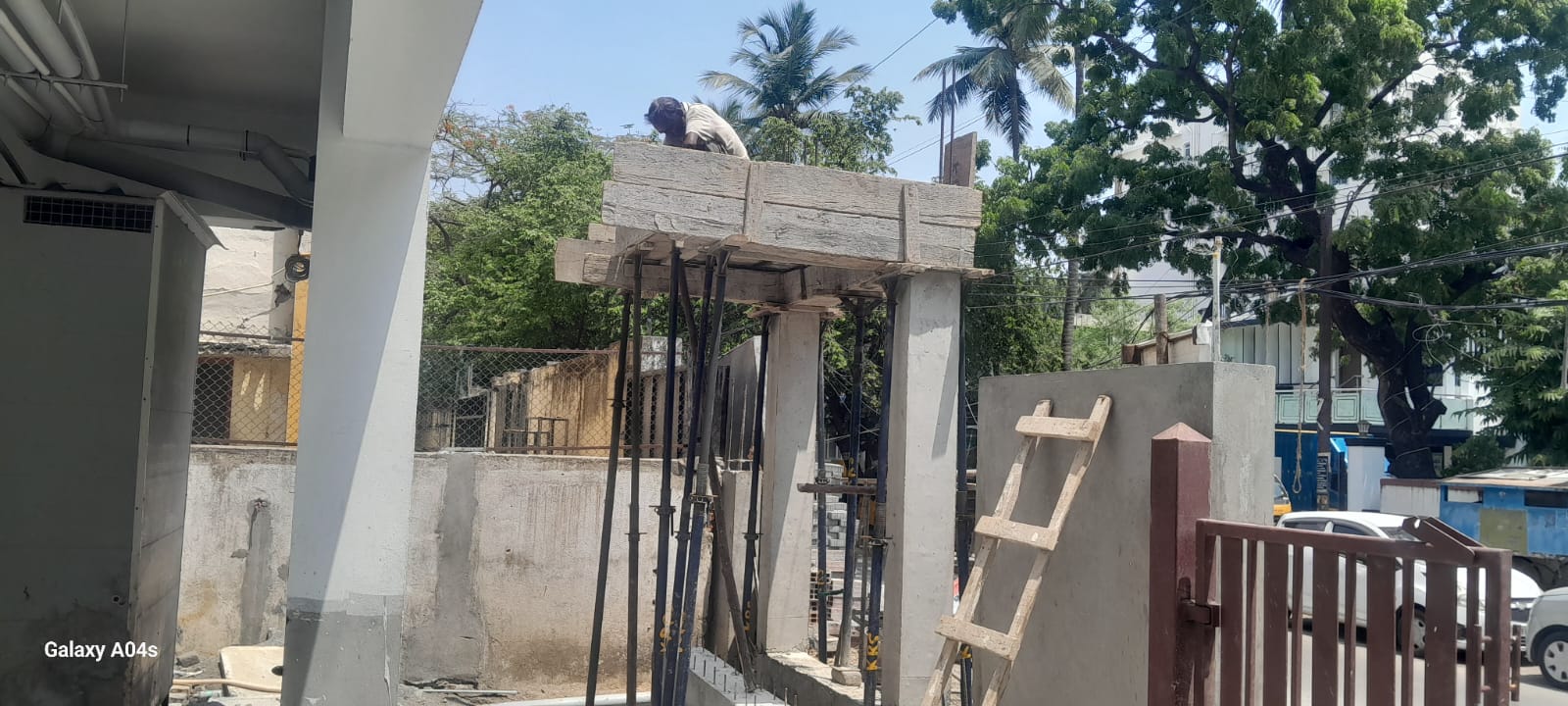

  • Lift erection work is in progress.(70% completed)

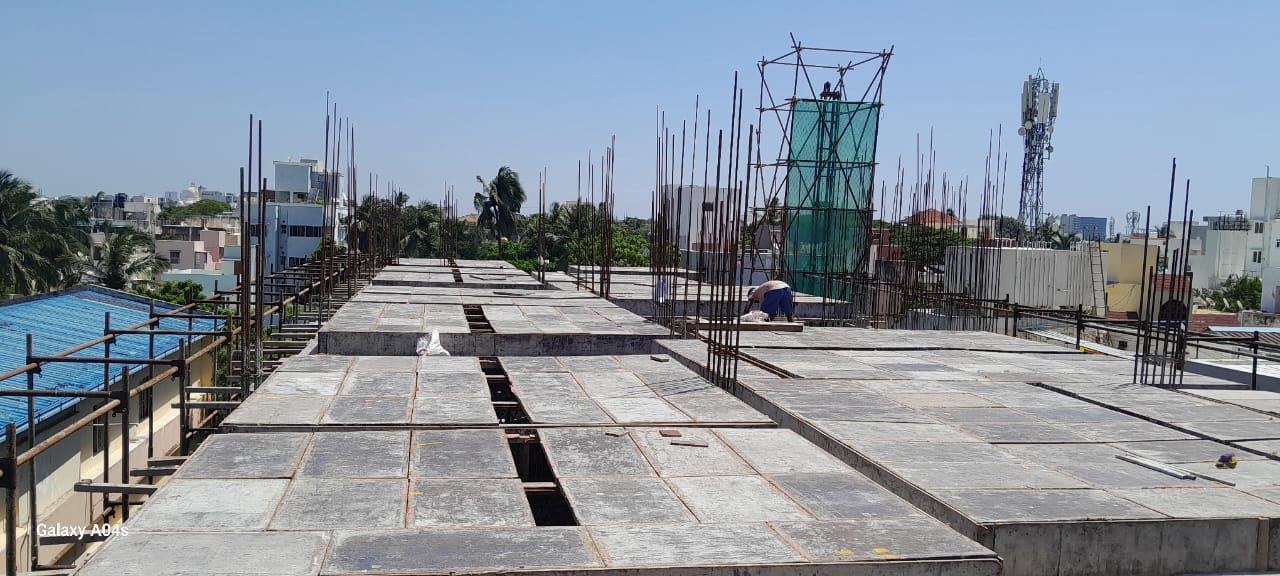

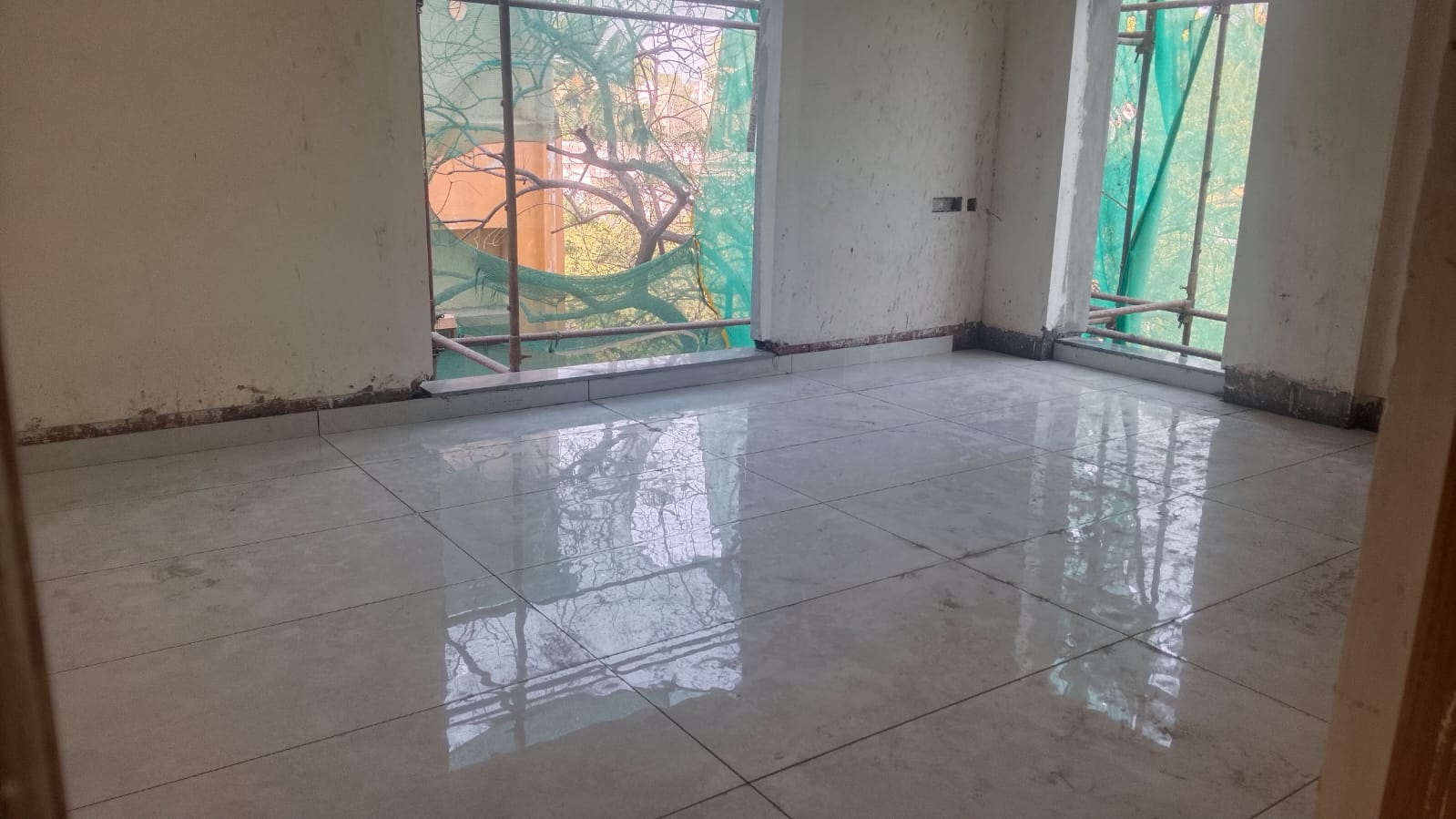

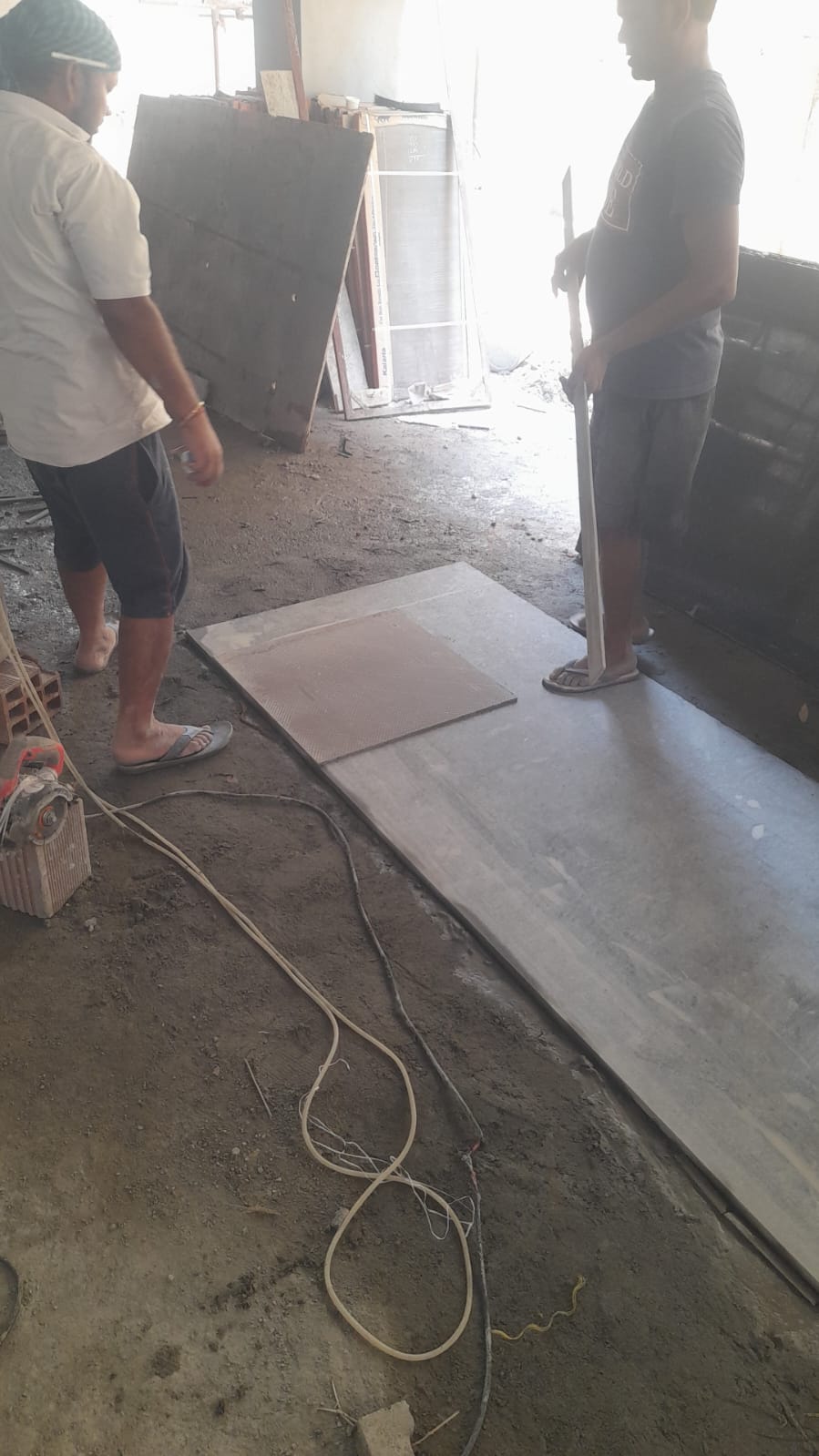

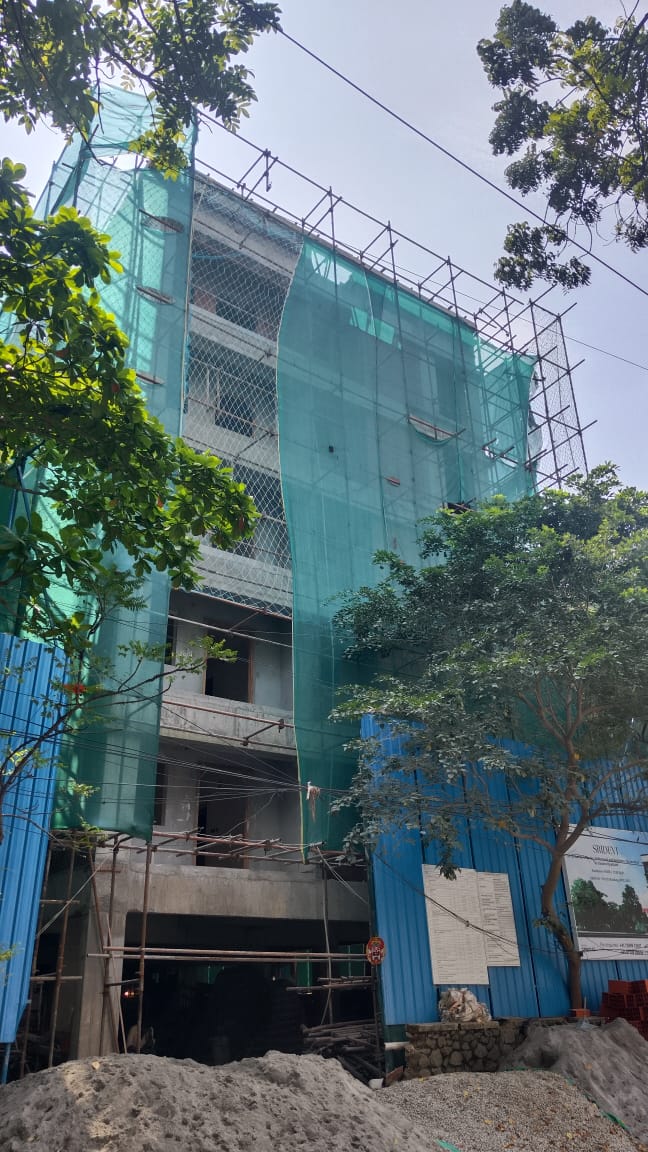

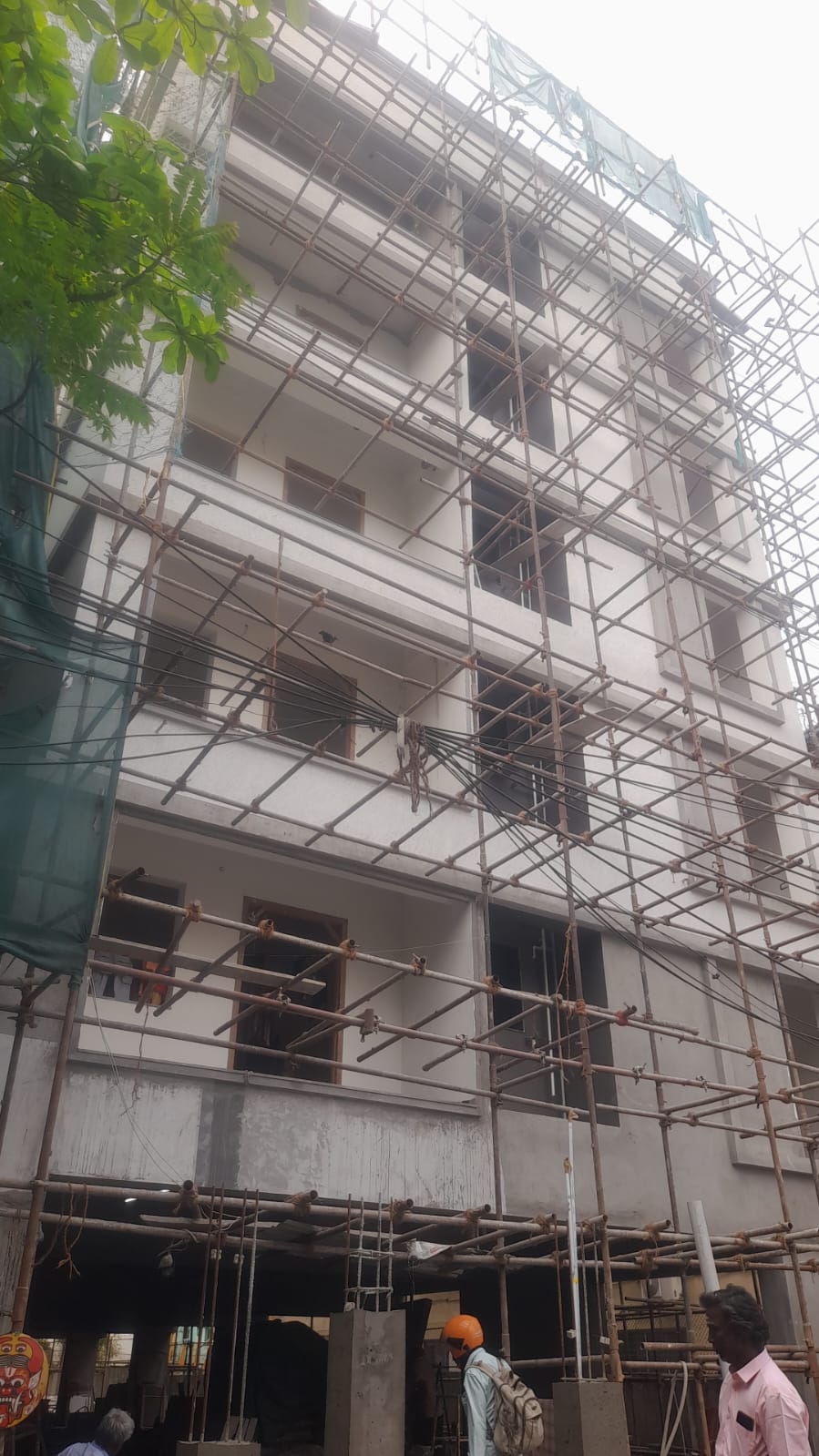

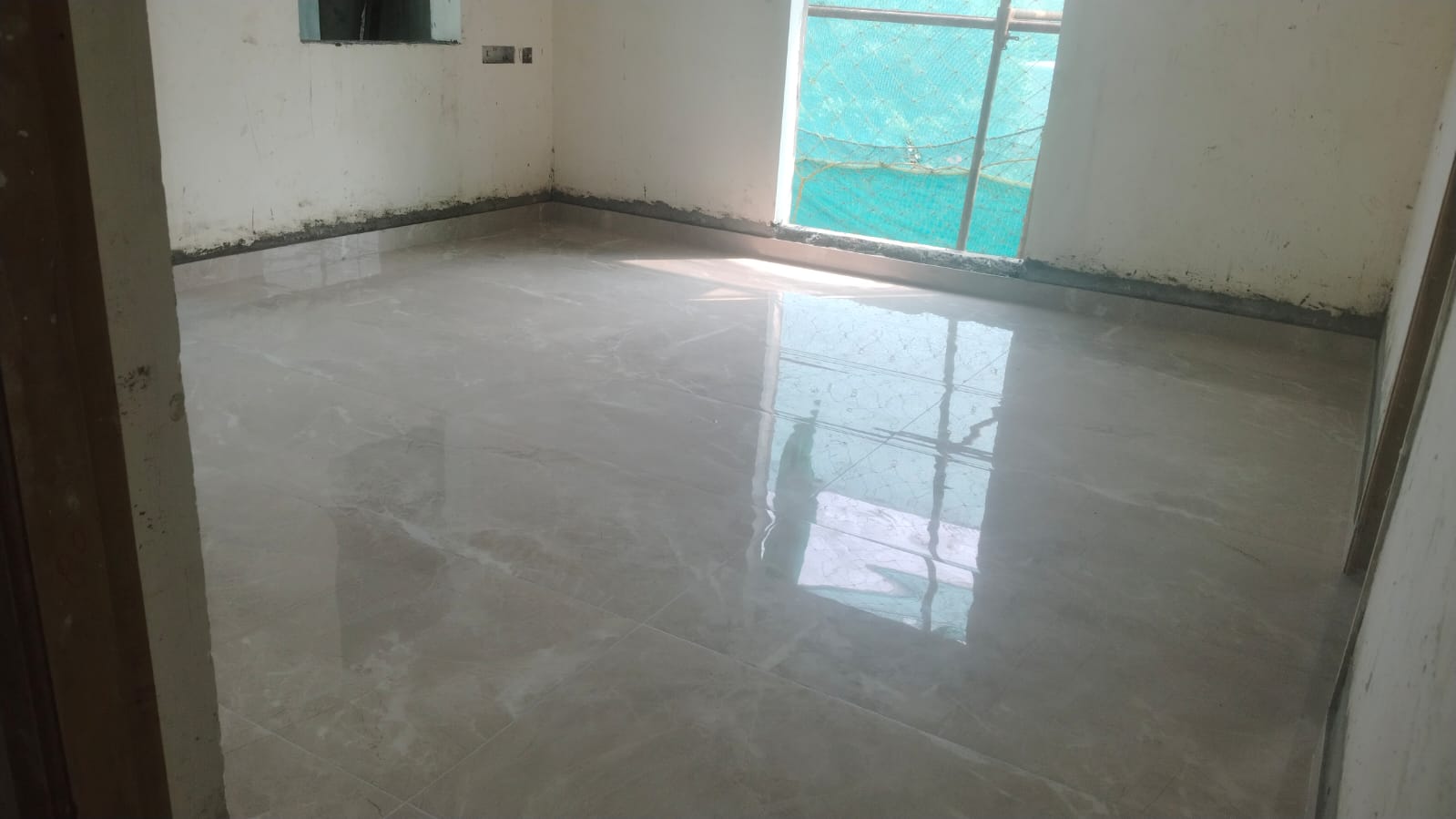

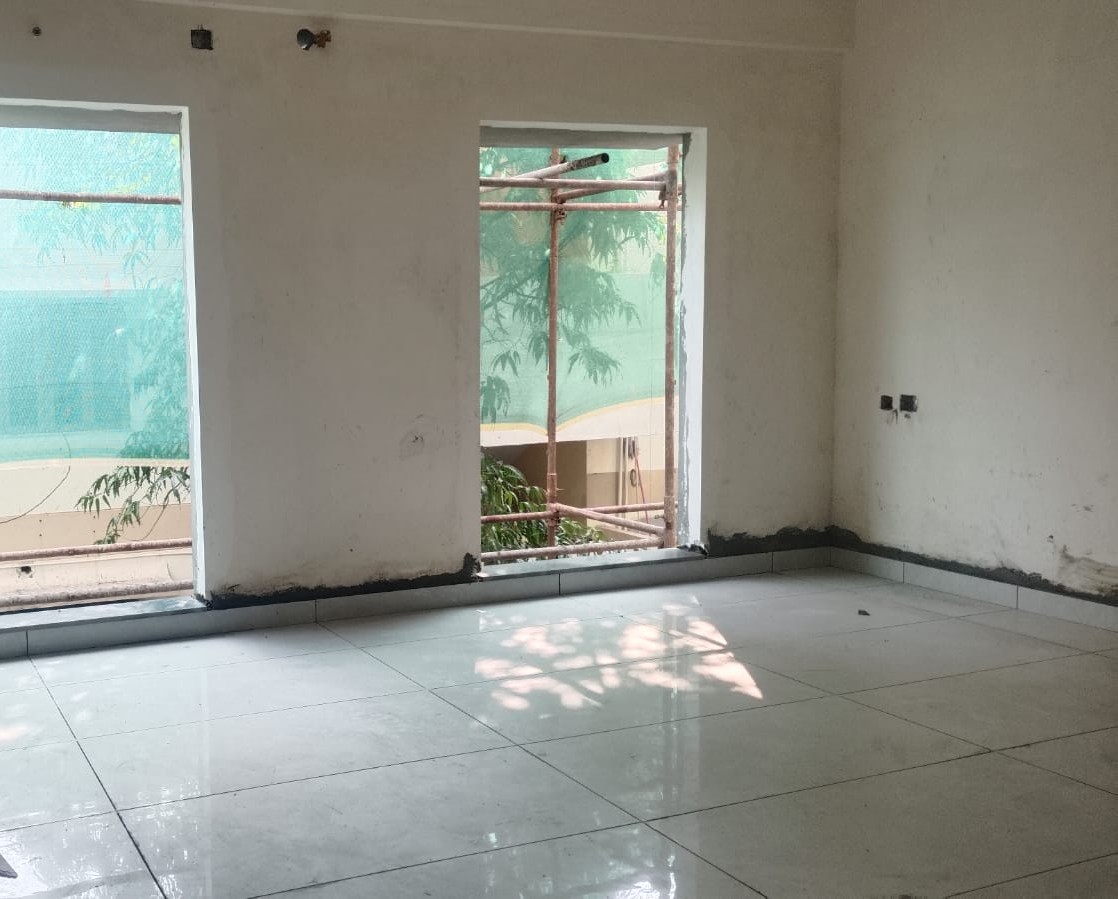

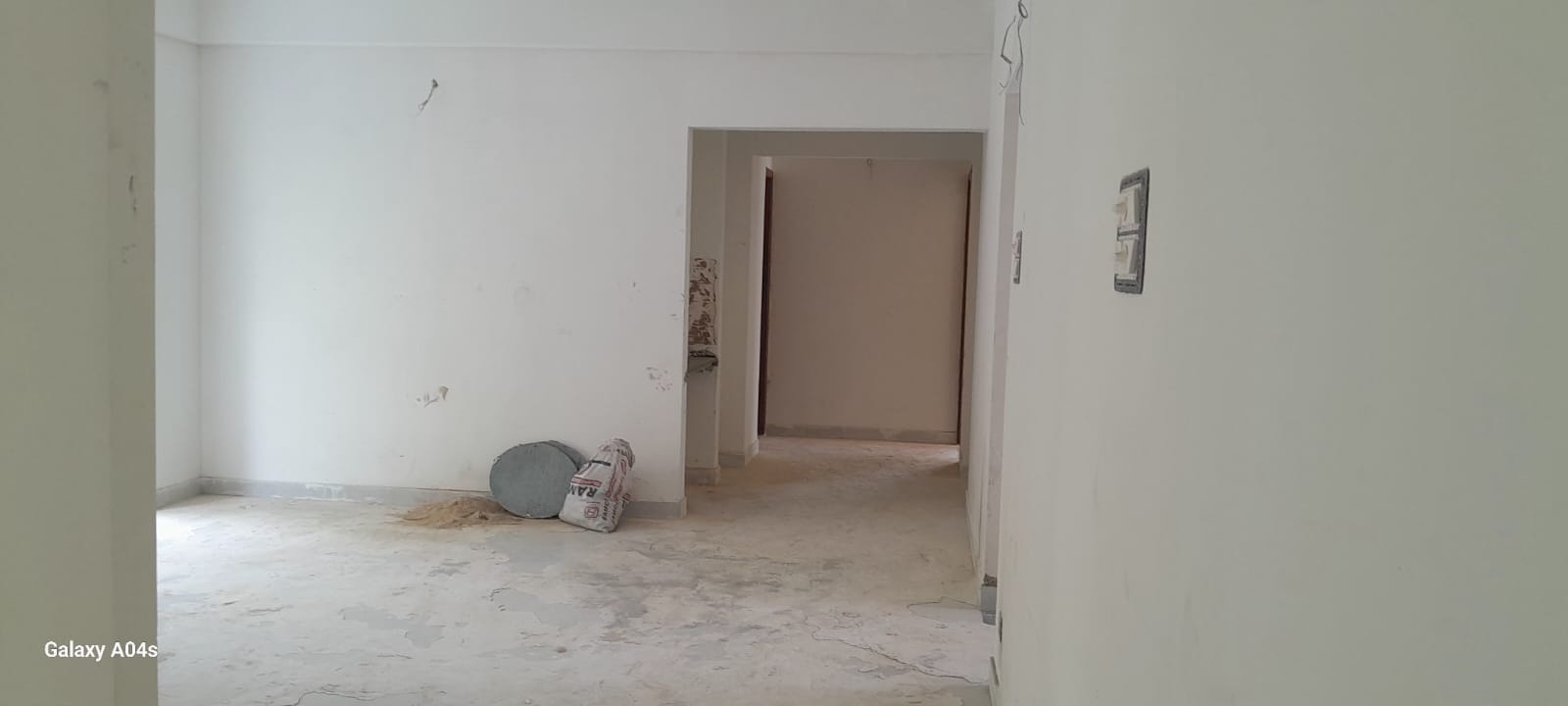

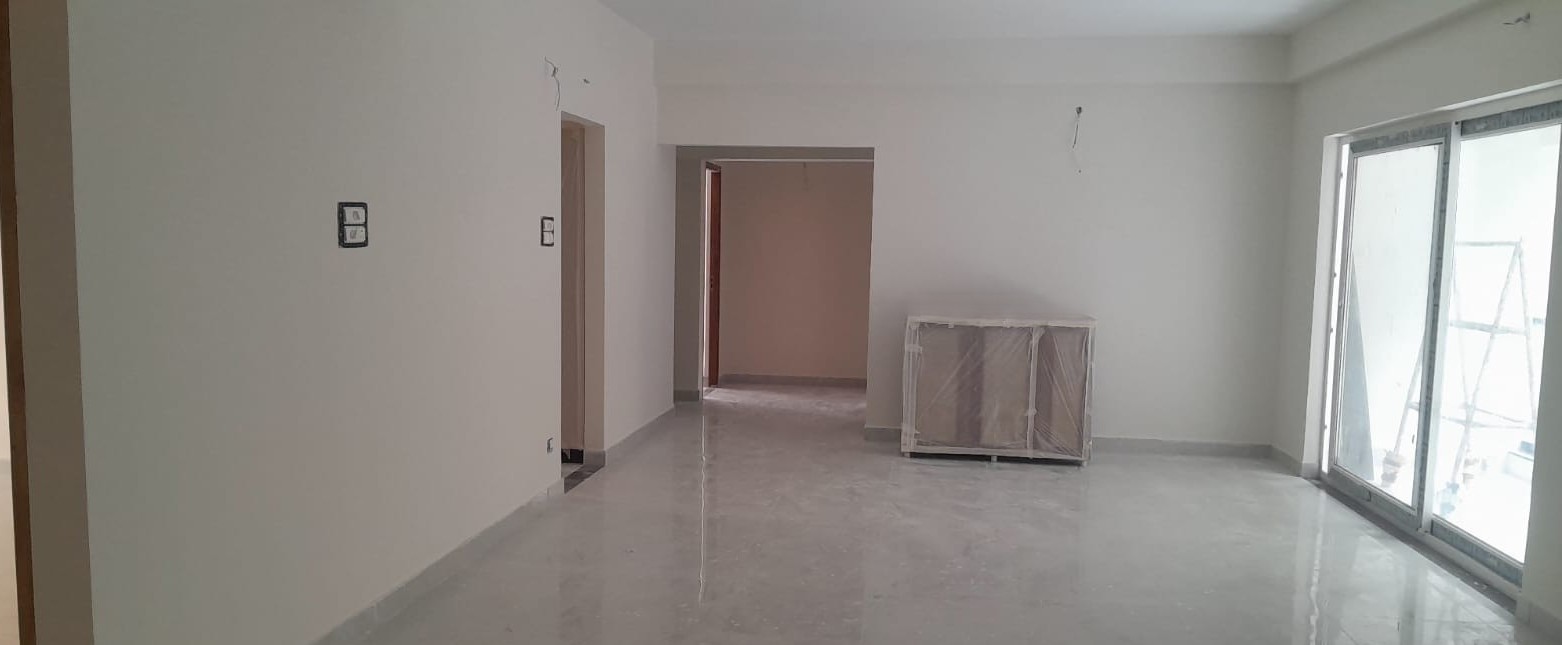

  • General flooring work is in progress.(Up to 4th floor completed,5th floor 95% completed)

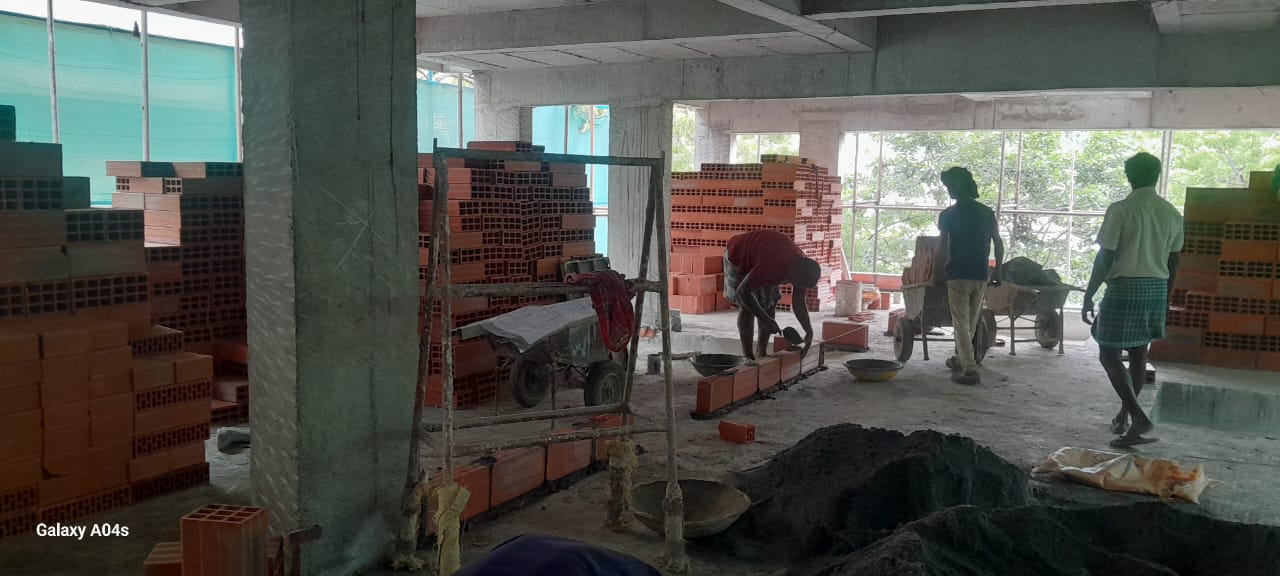

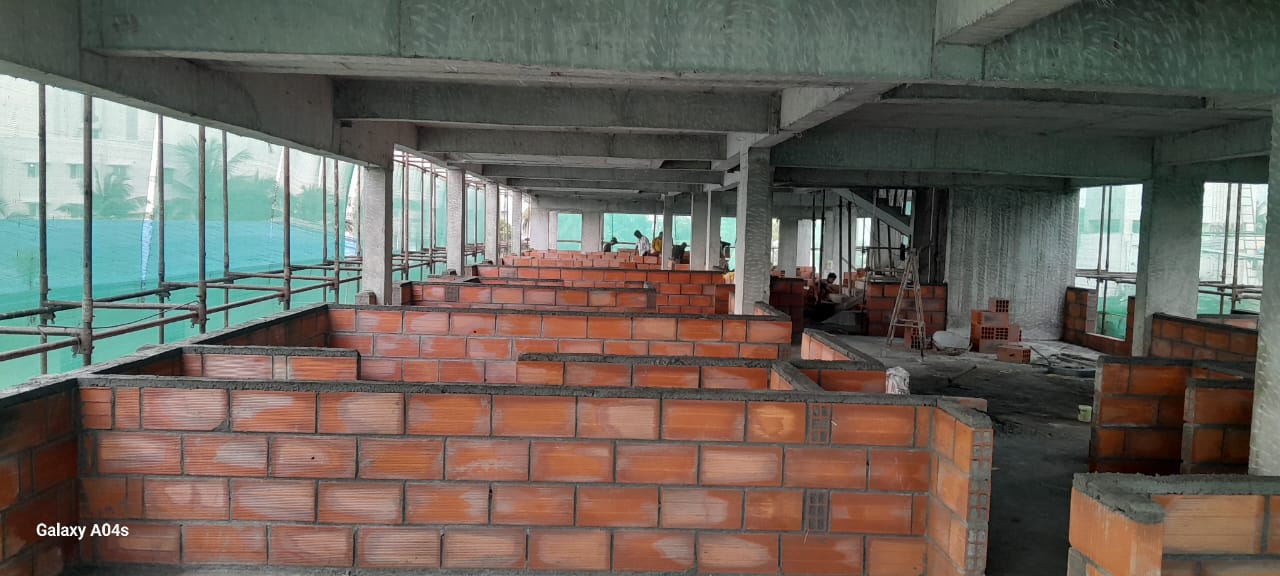

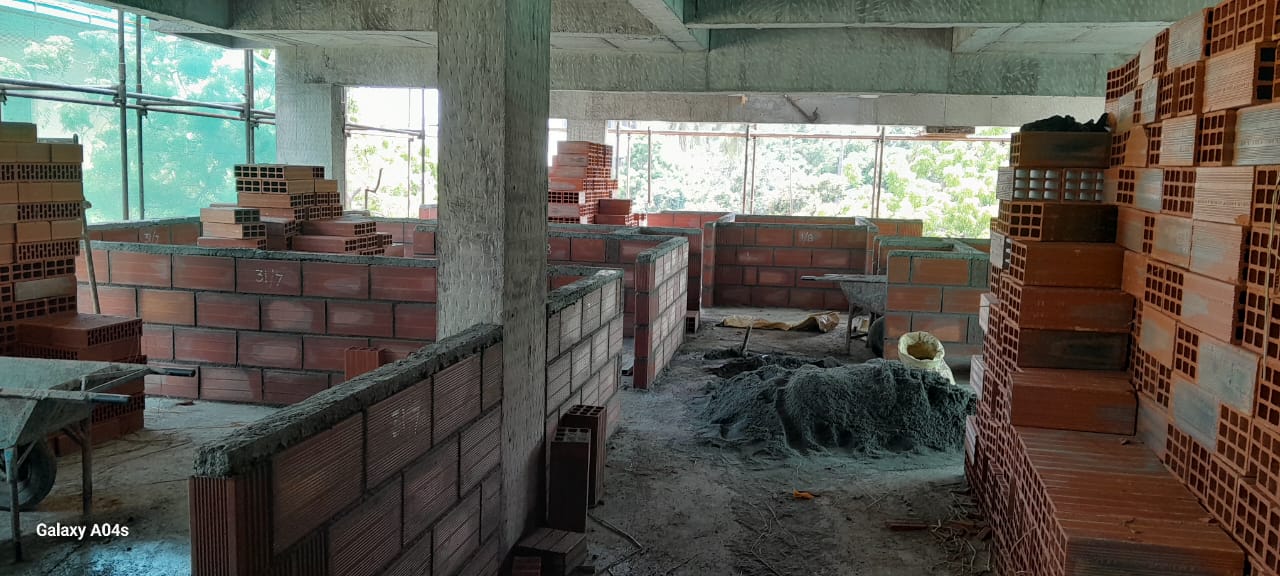

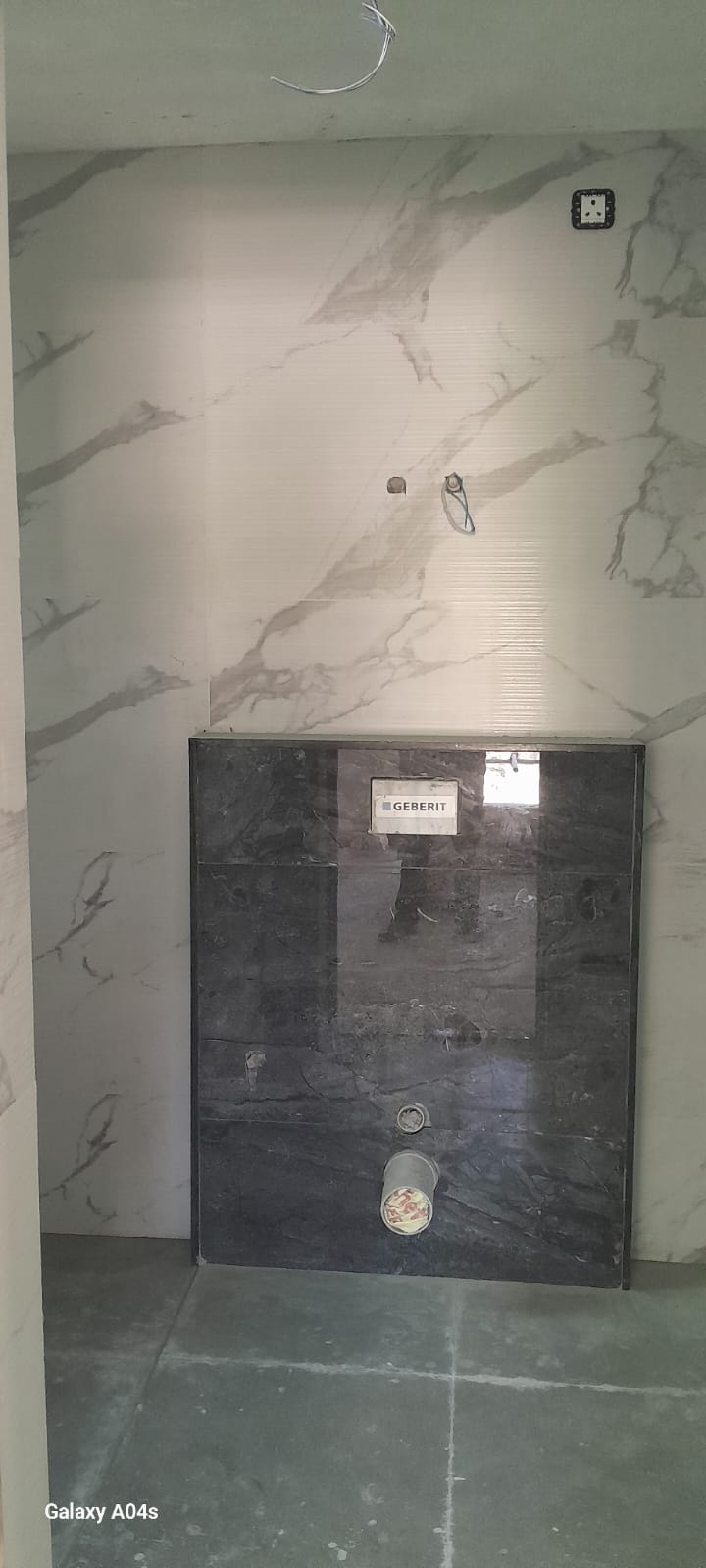

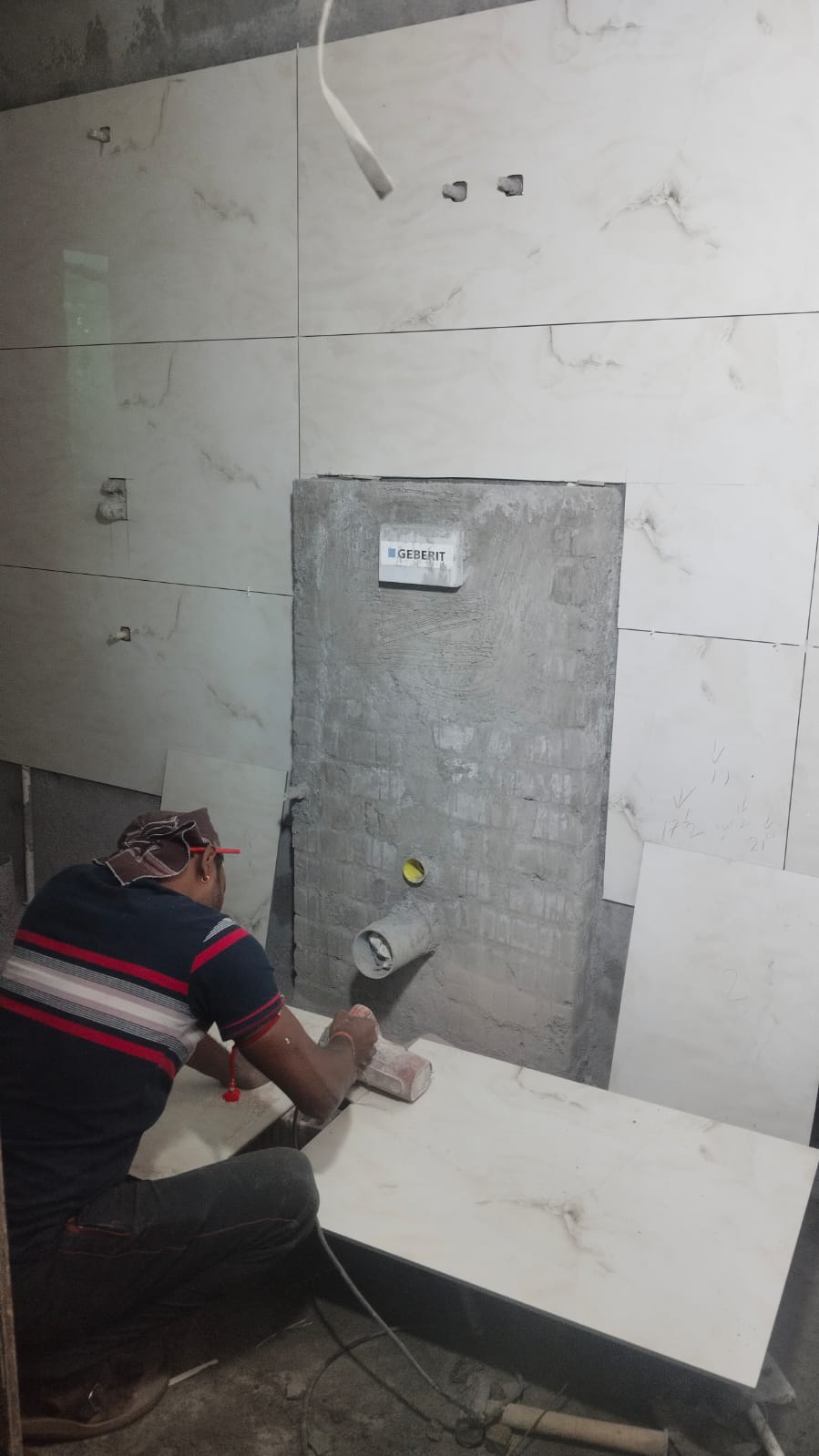

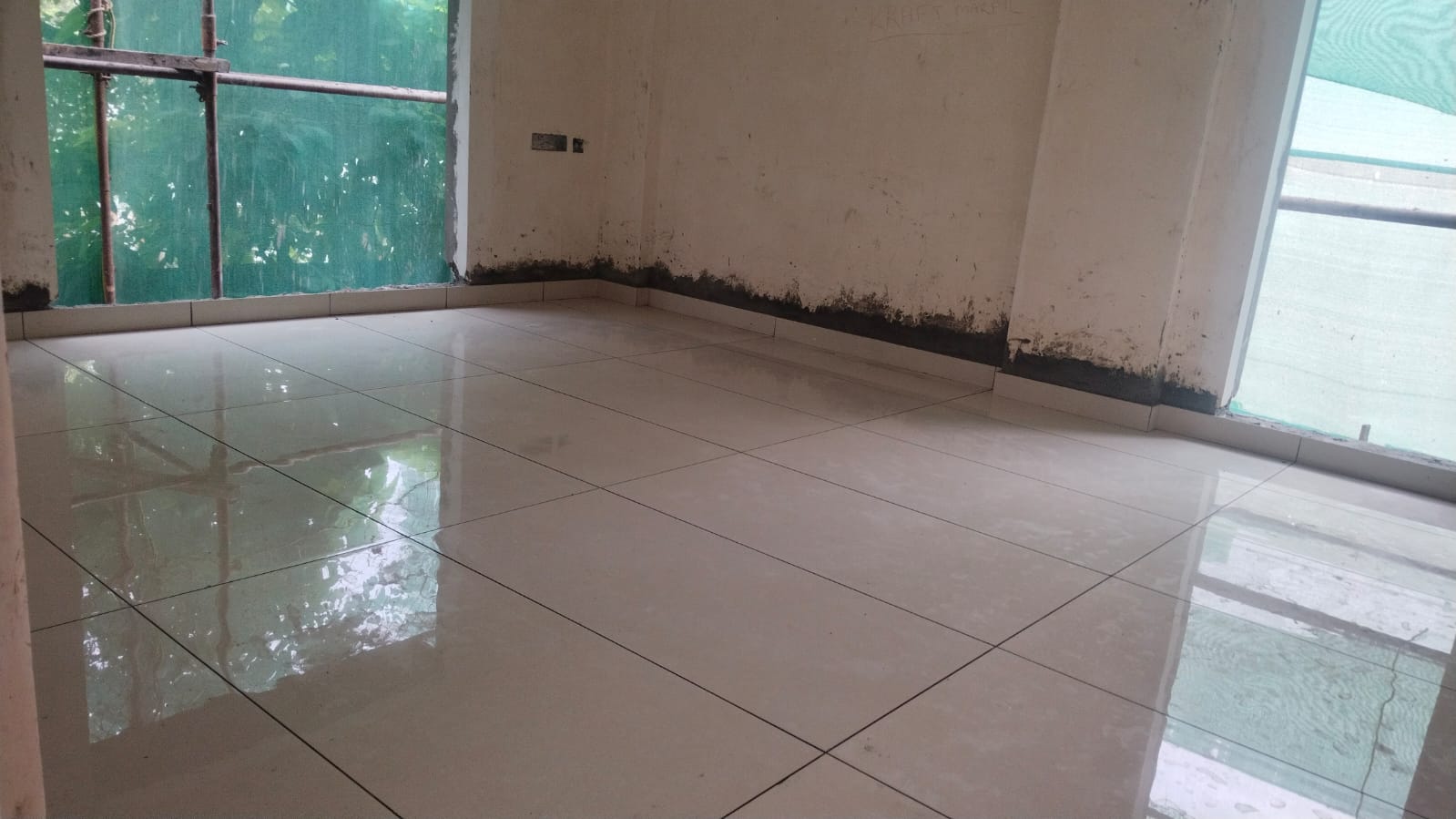

  • Toilet tiles work is completed.

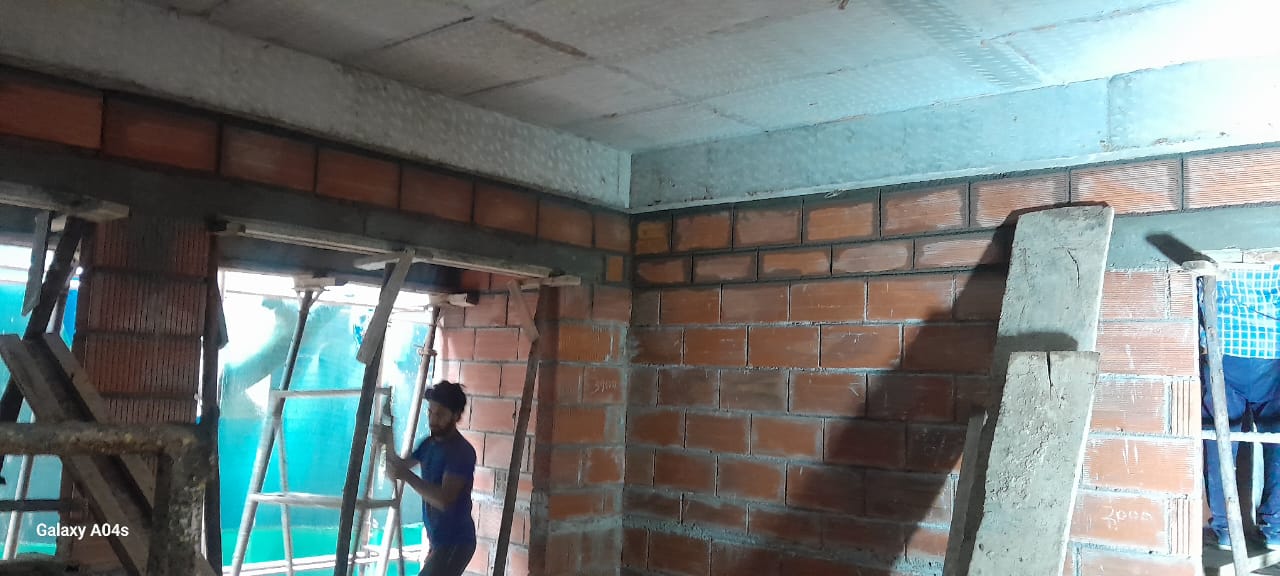

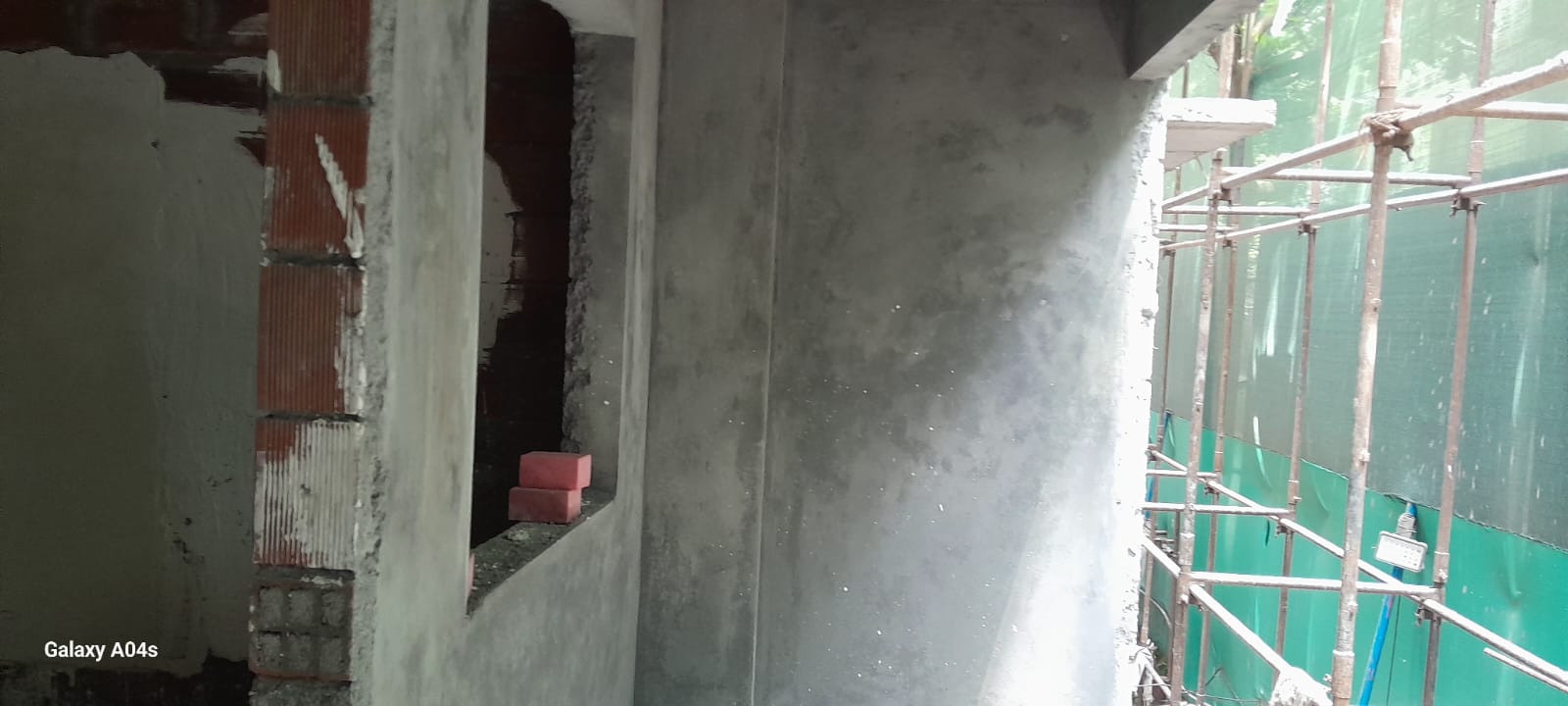

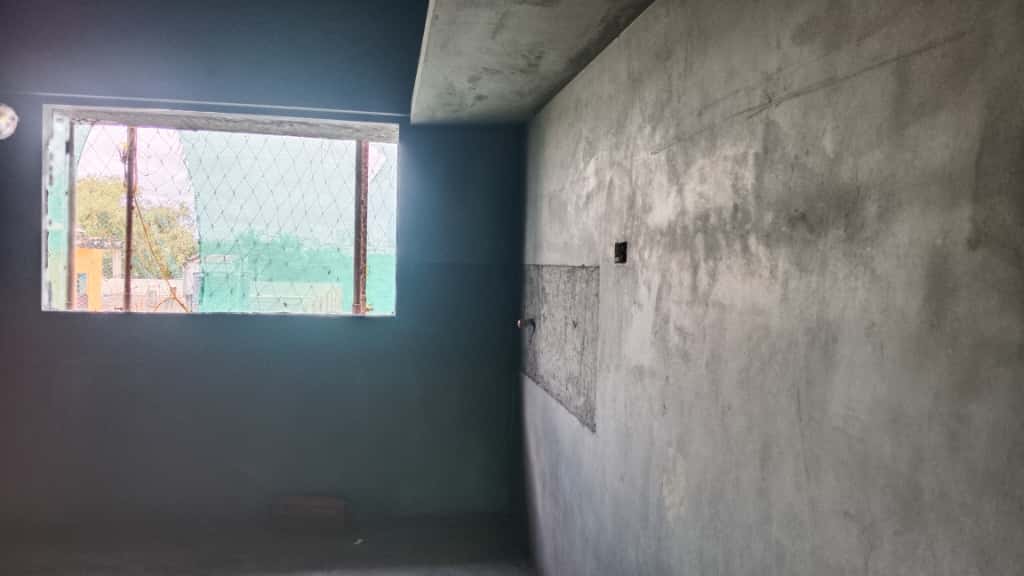

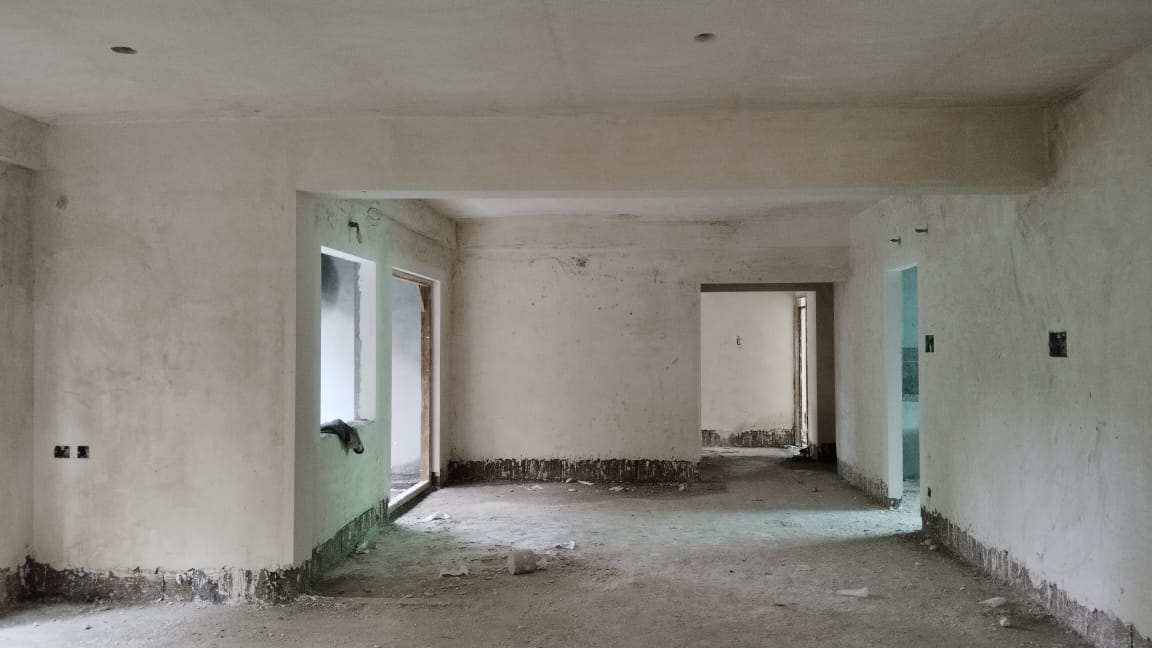

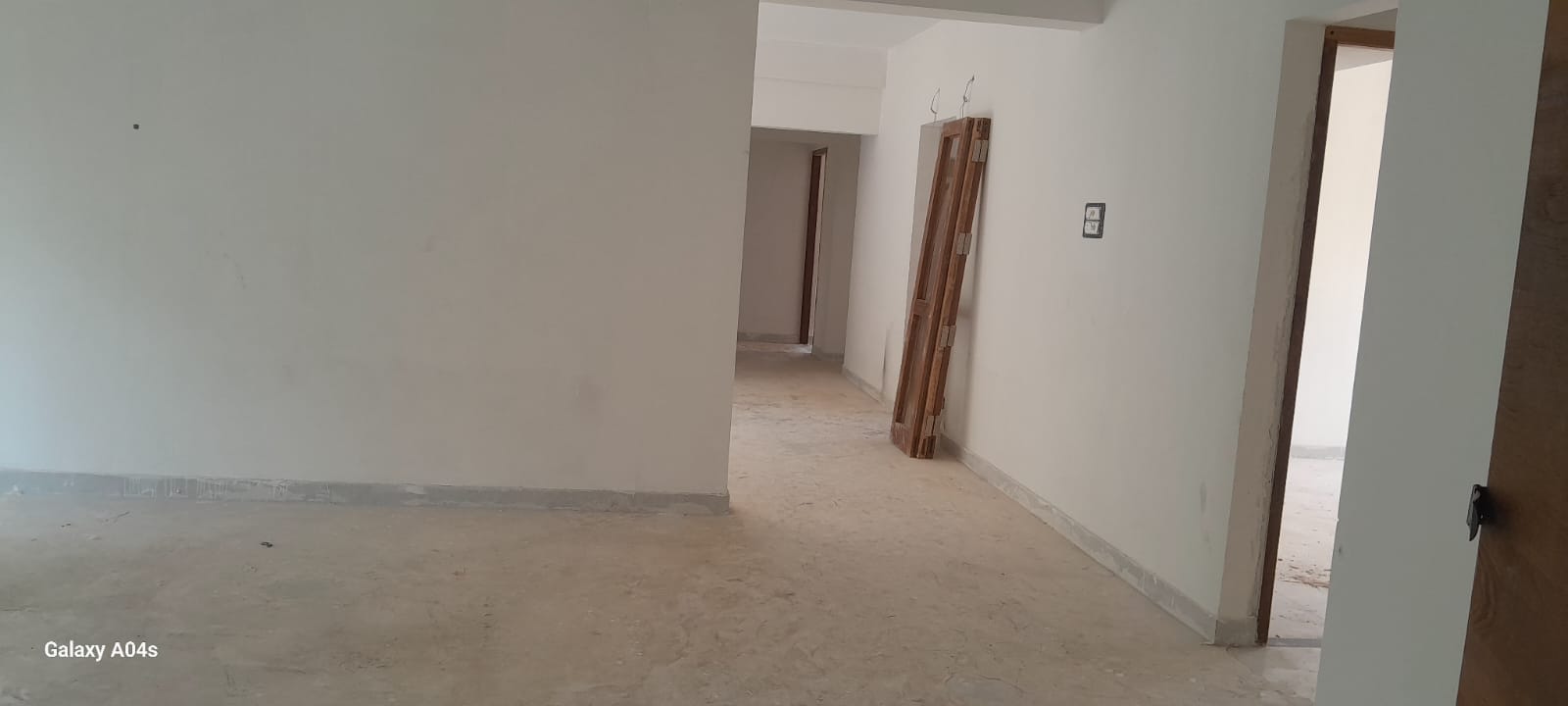

  • Inner putty work is in progress. (up to 4th floor completed,5th floor 50% completed)
  • 5th Floor inner primer work is in progress. (Up to 4th floor completed)

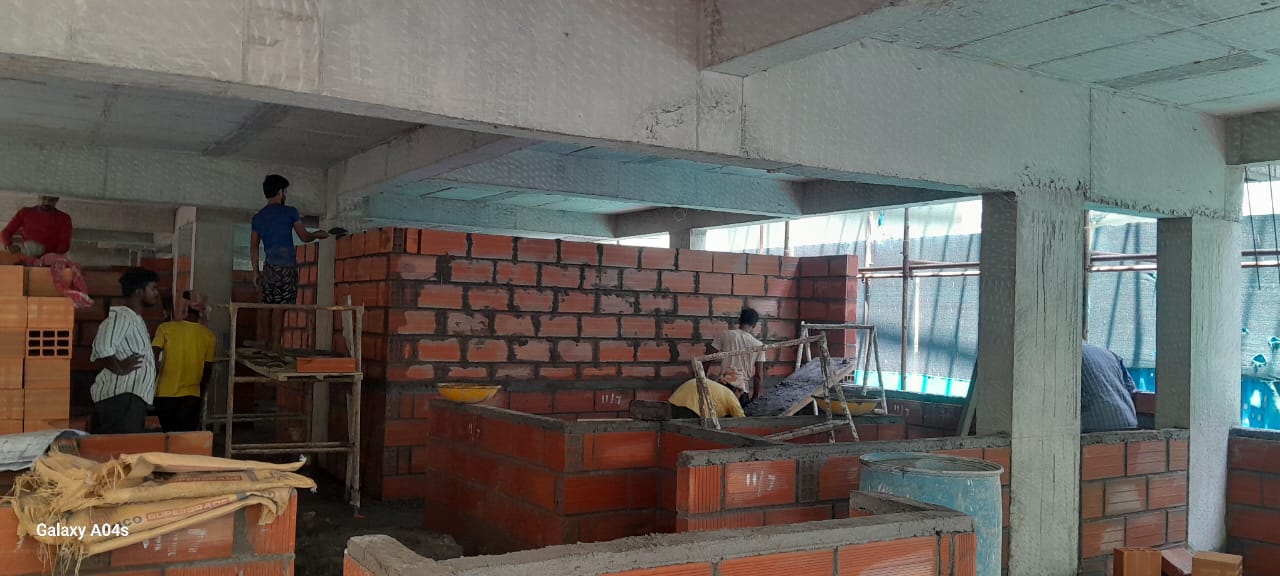

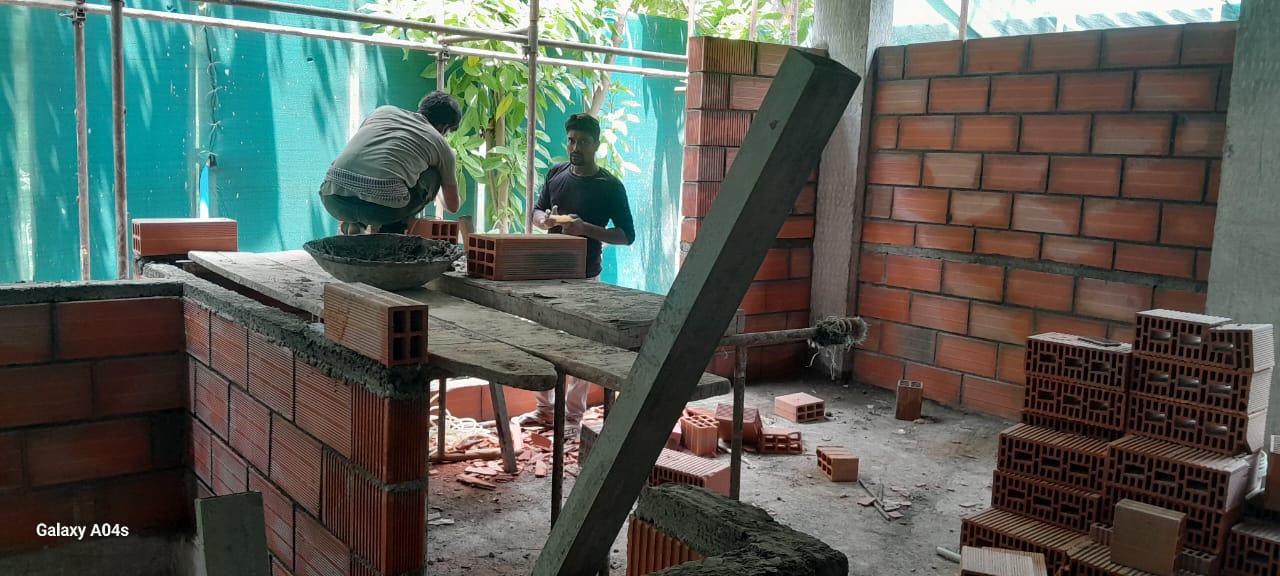

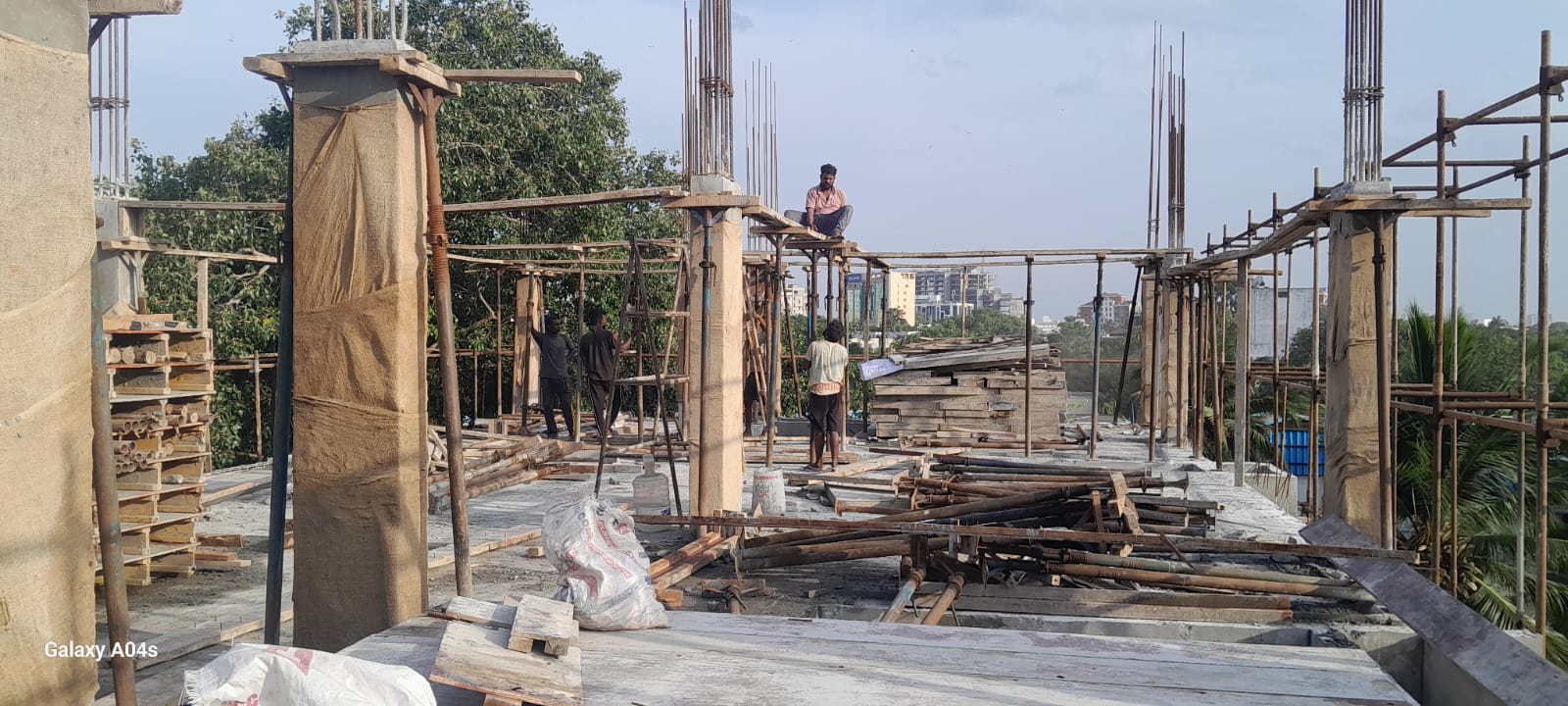

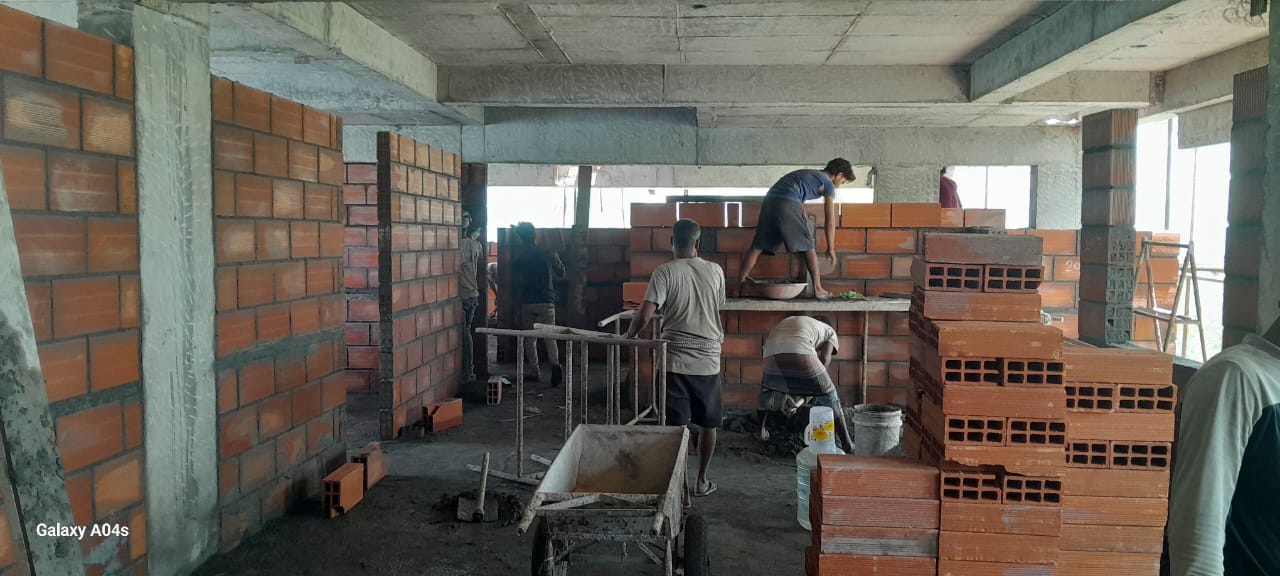

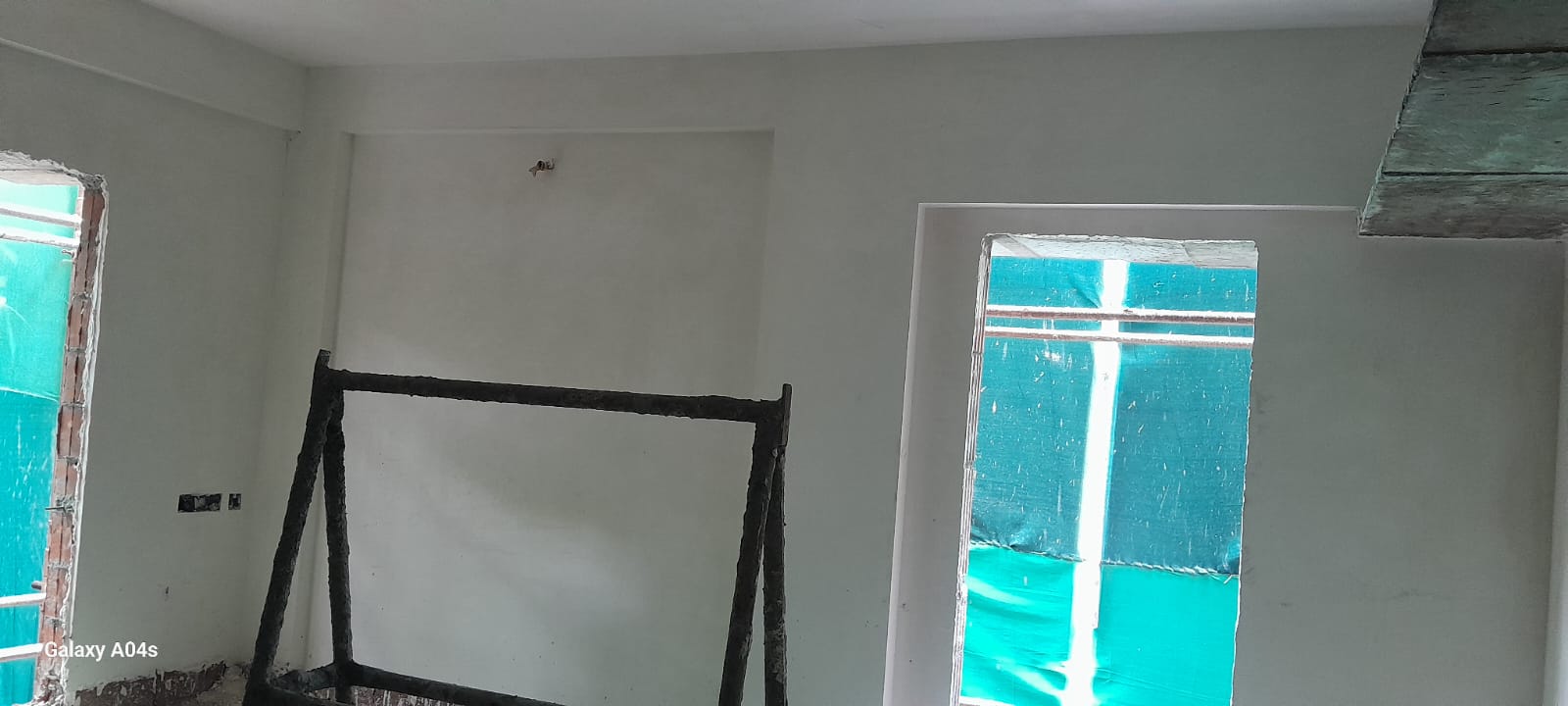

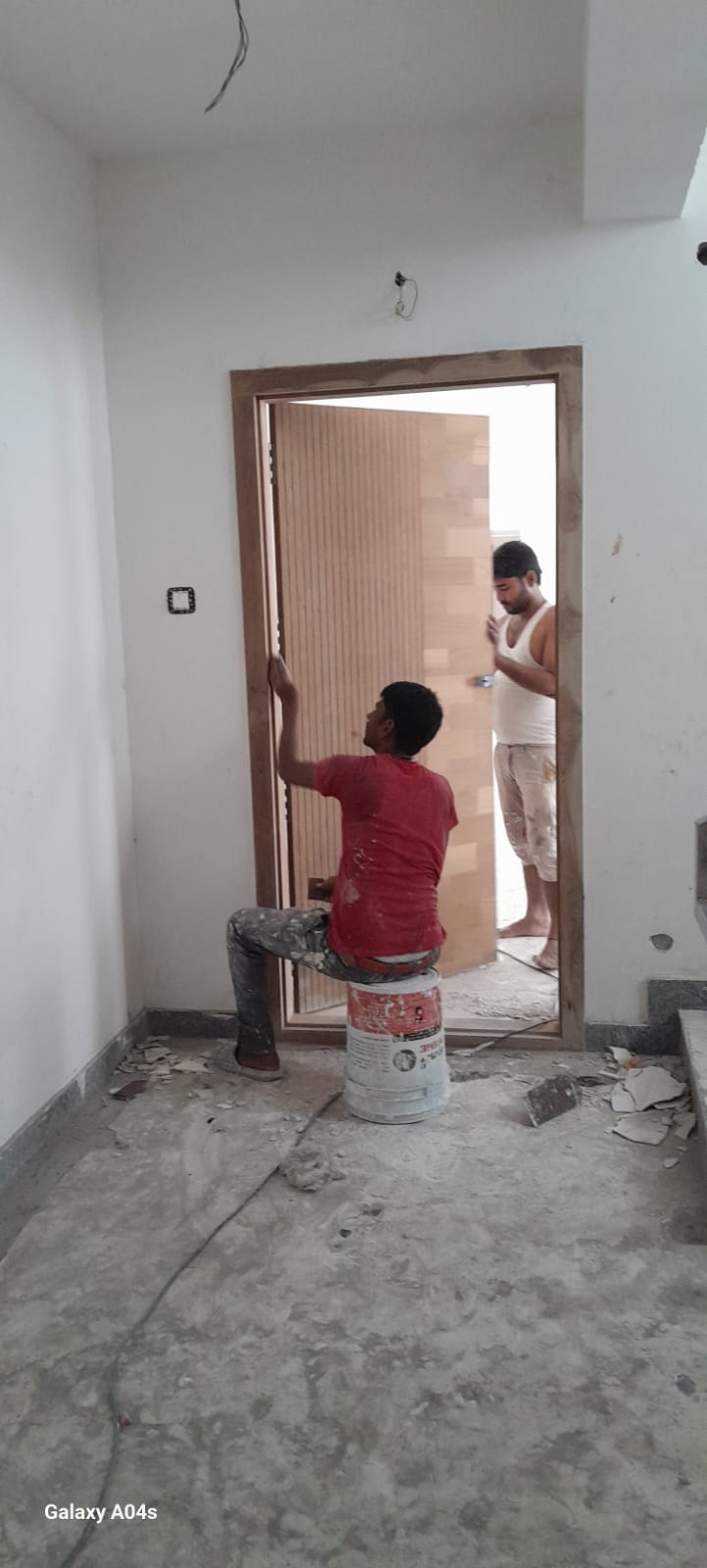

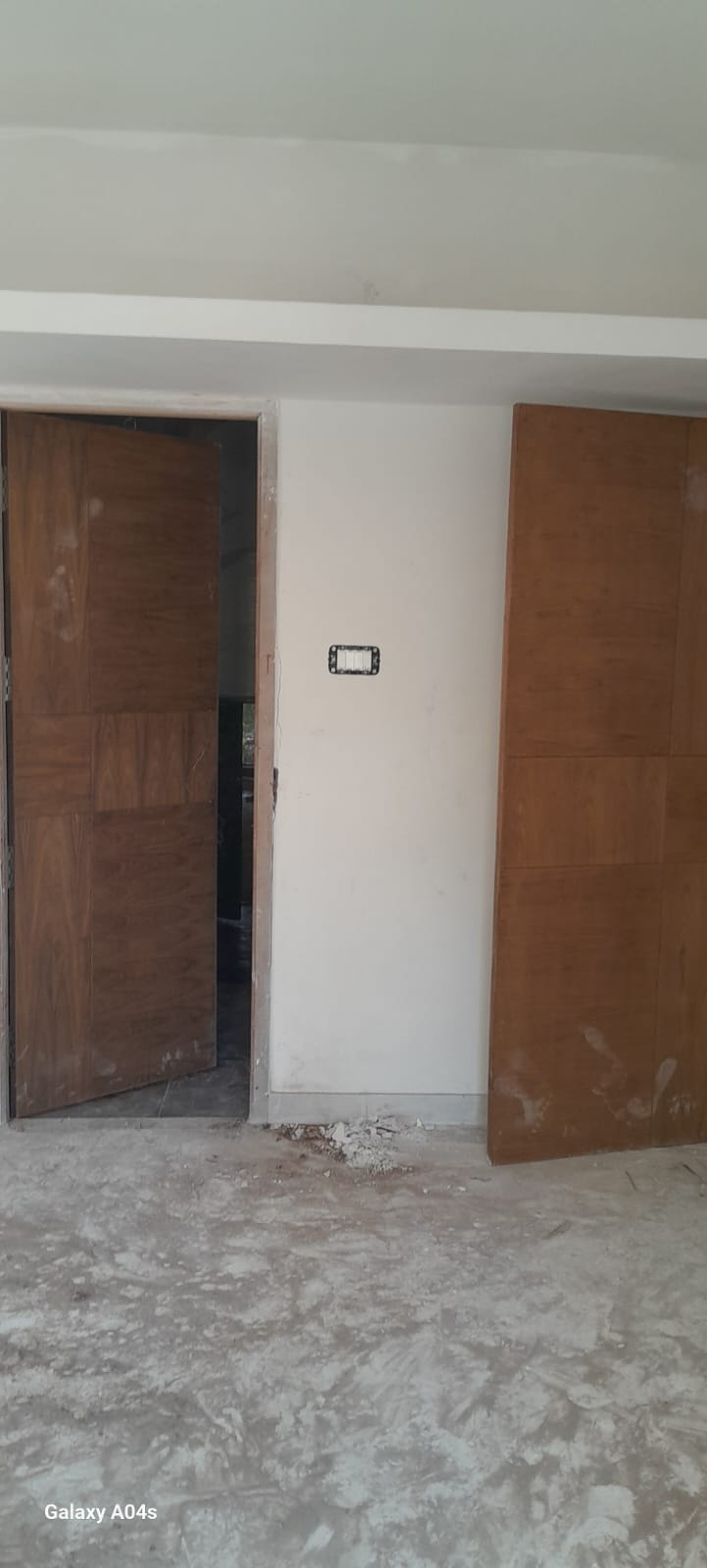

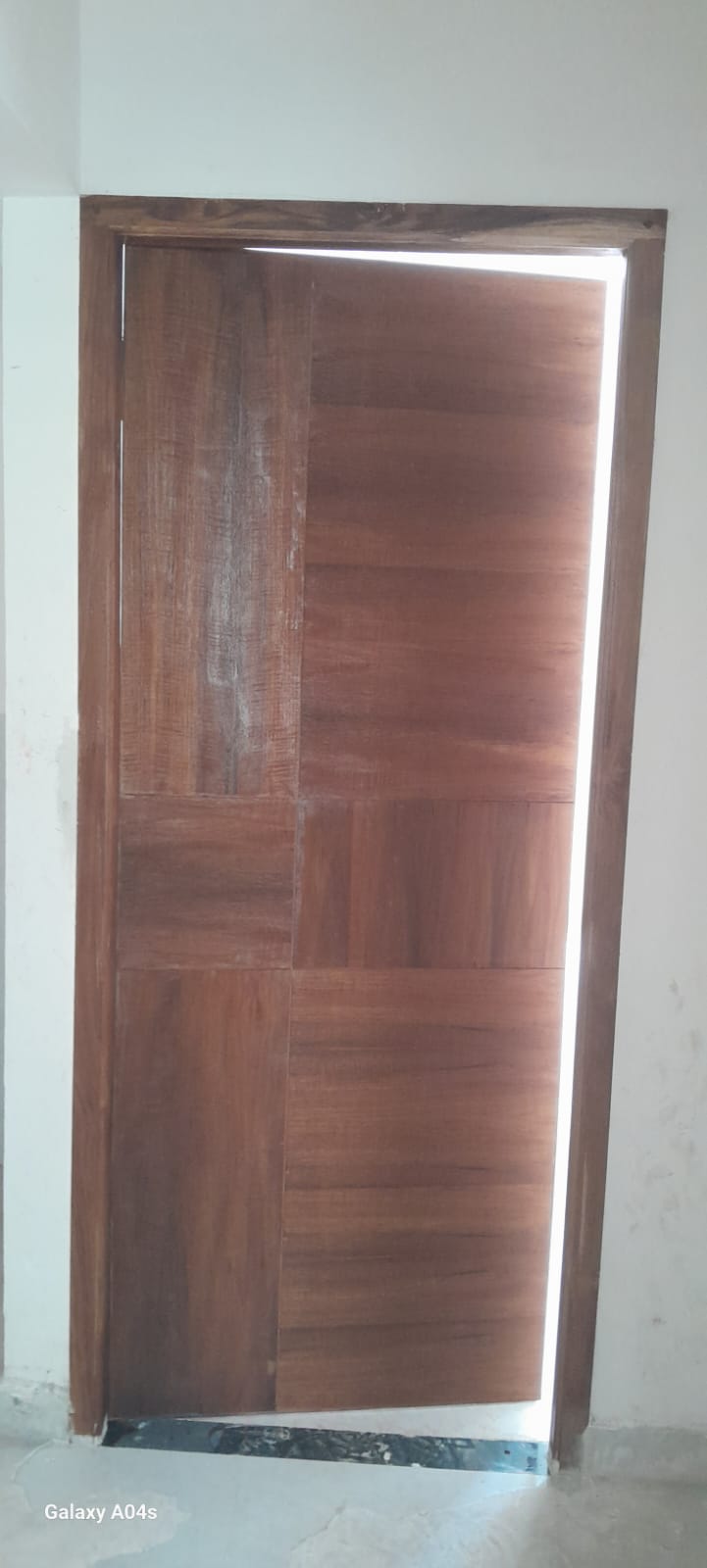

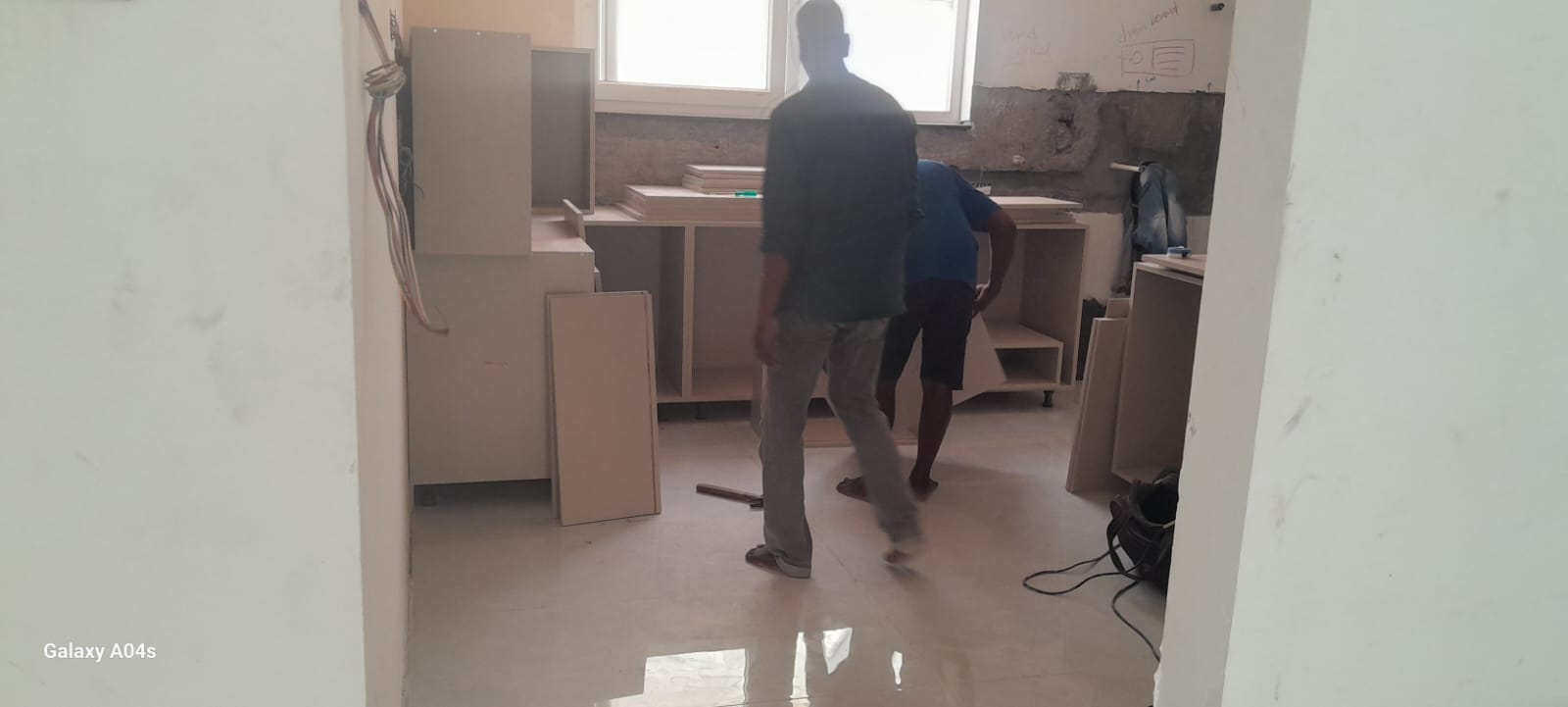

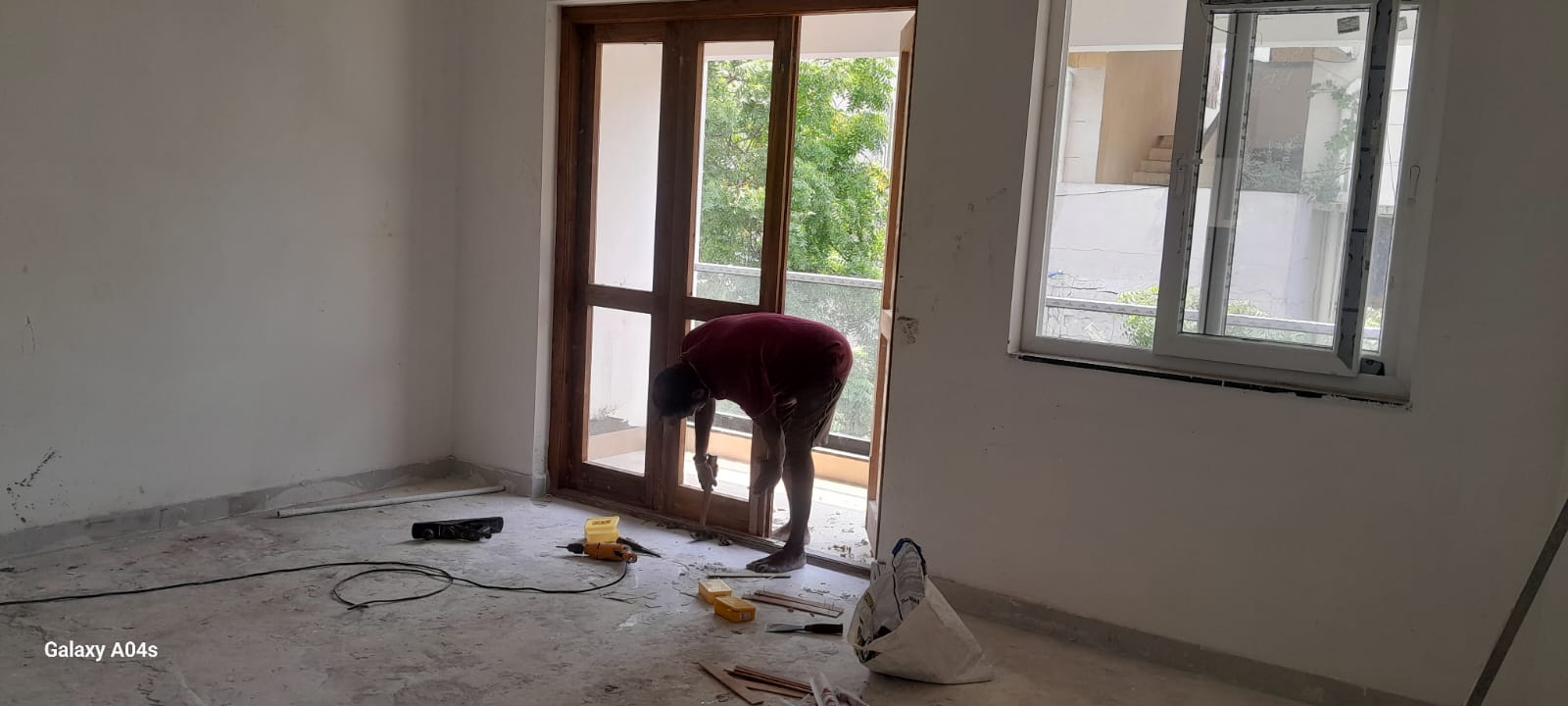

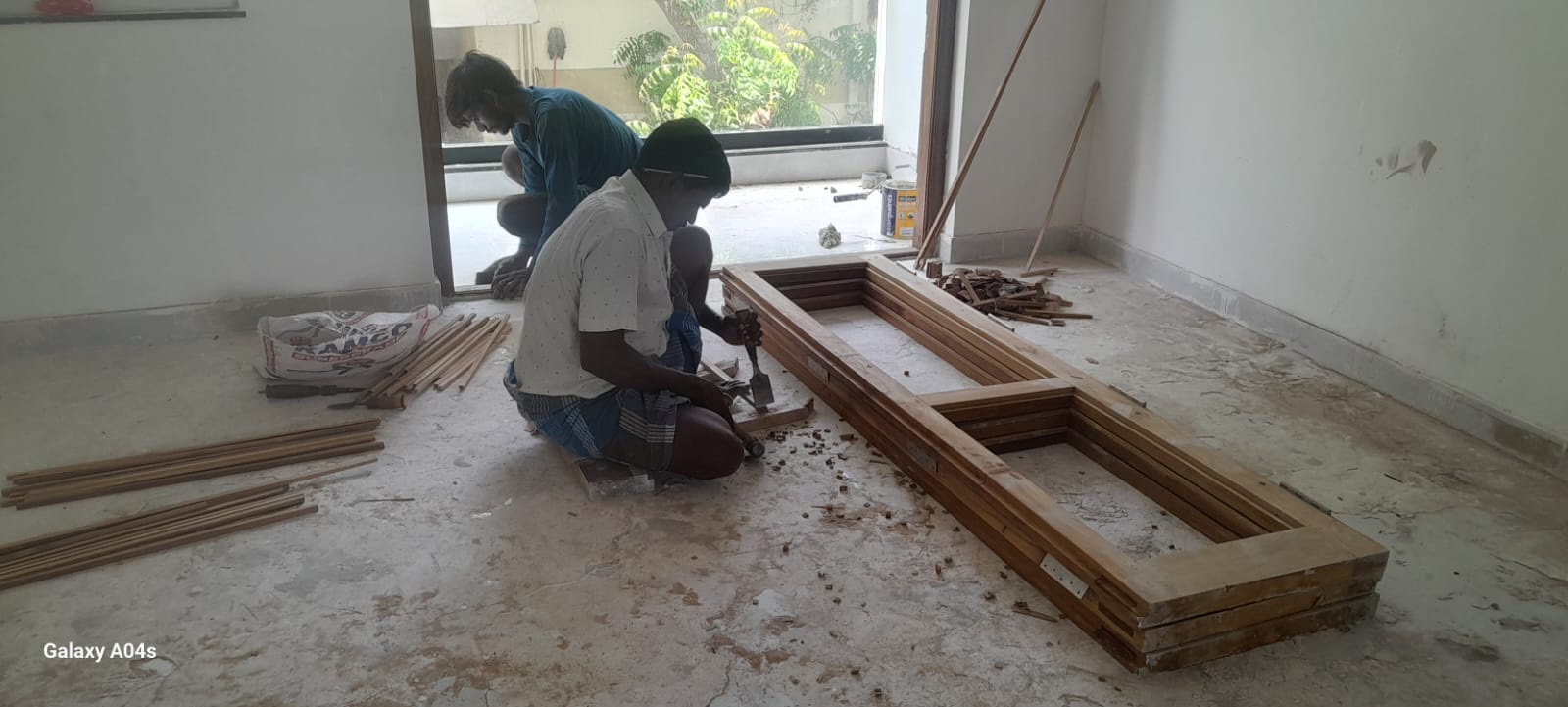

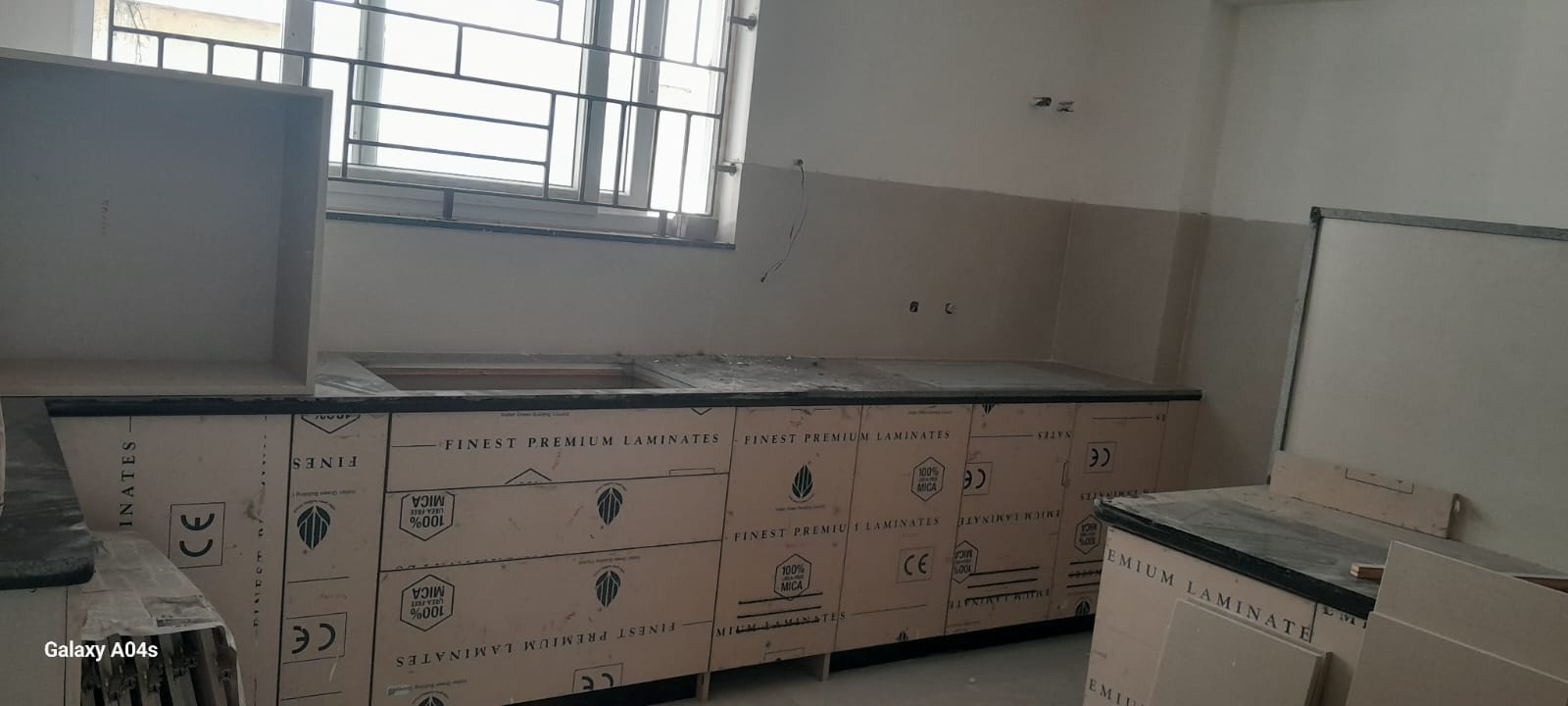

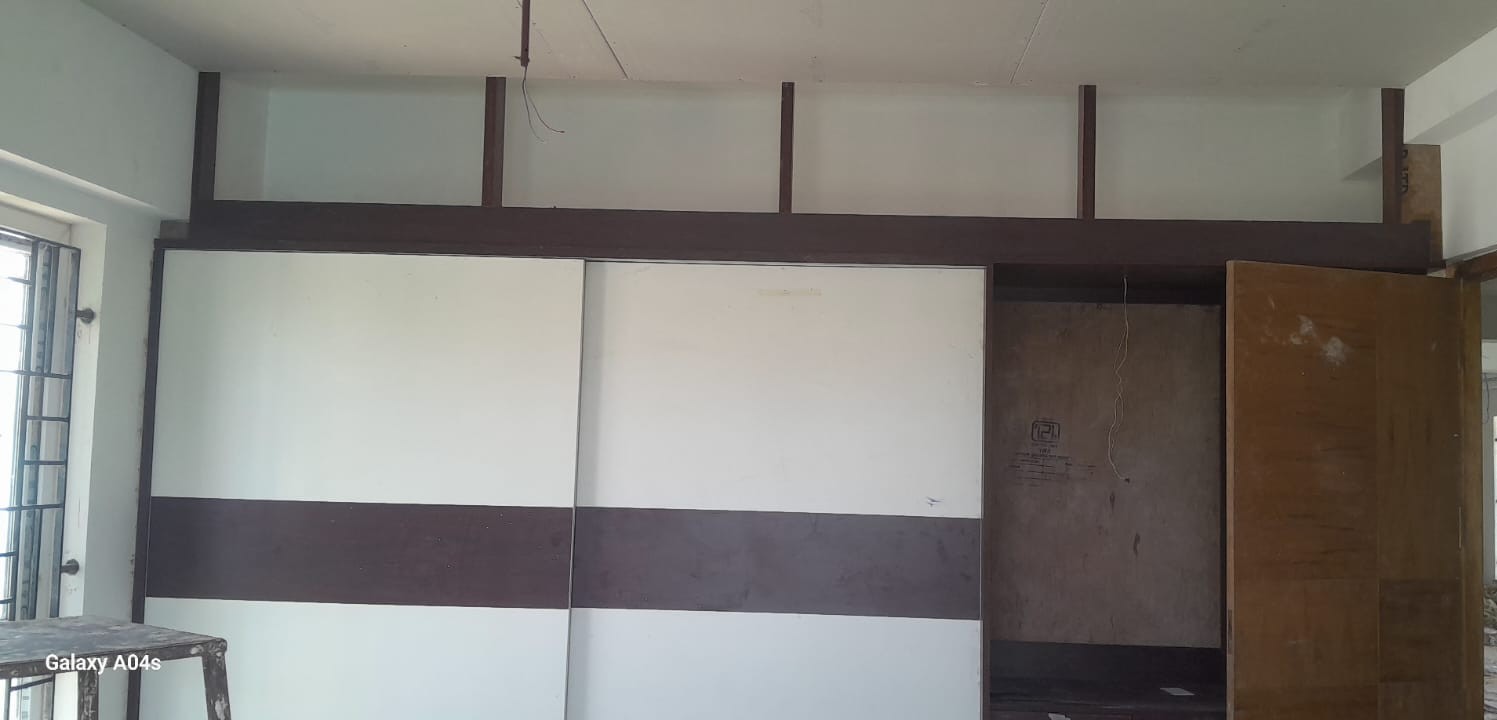

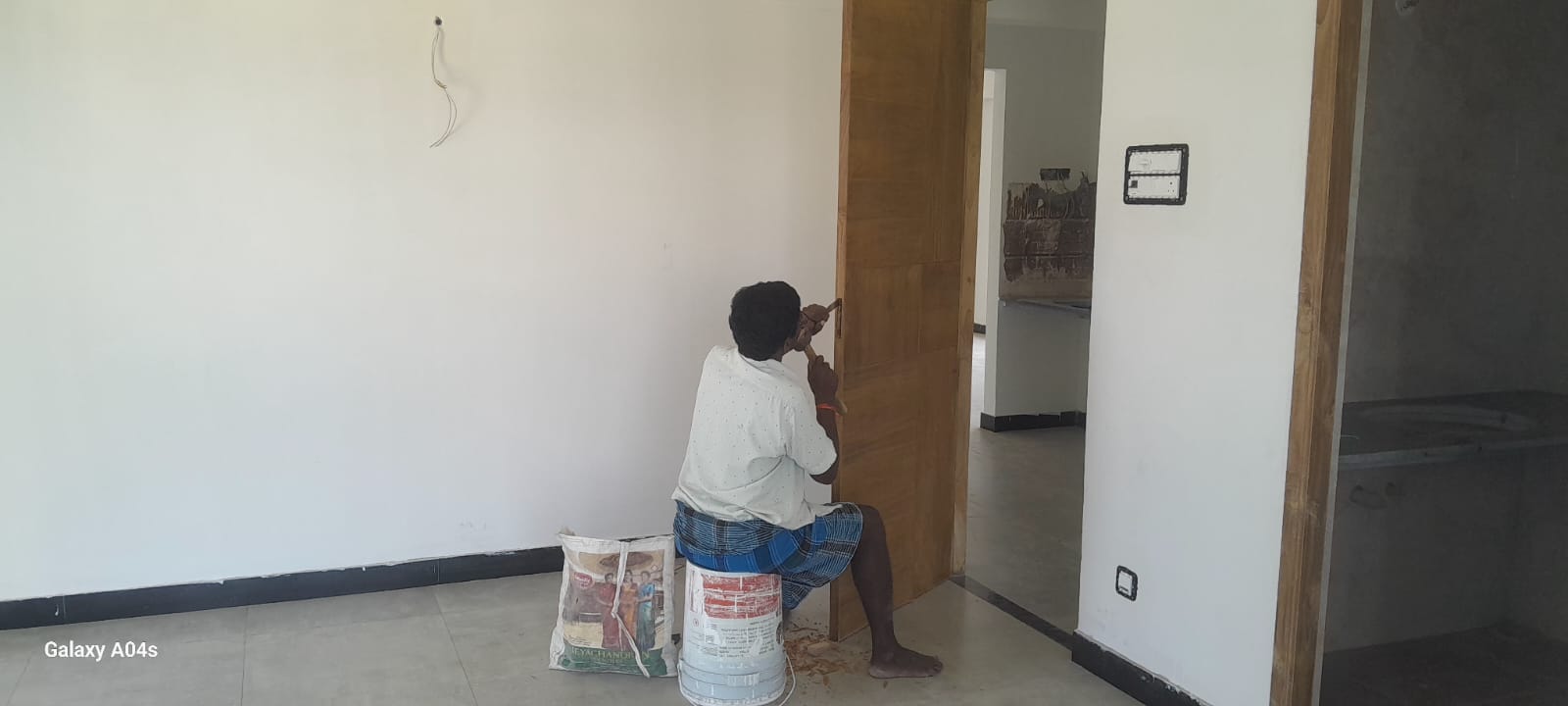

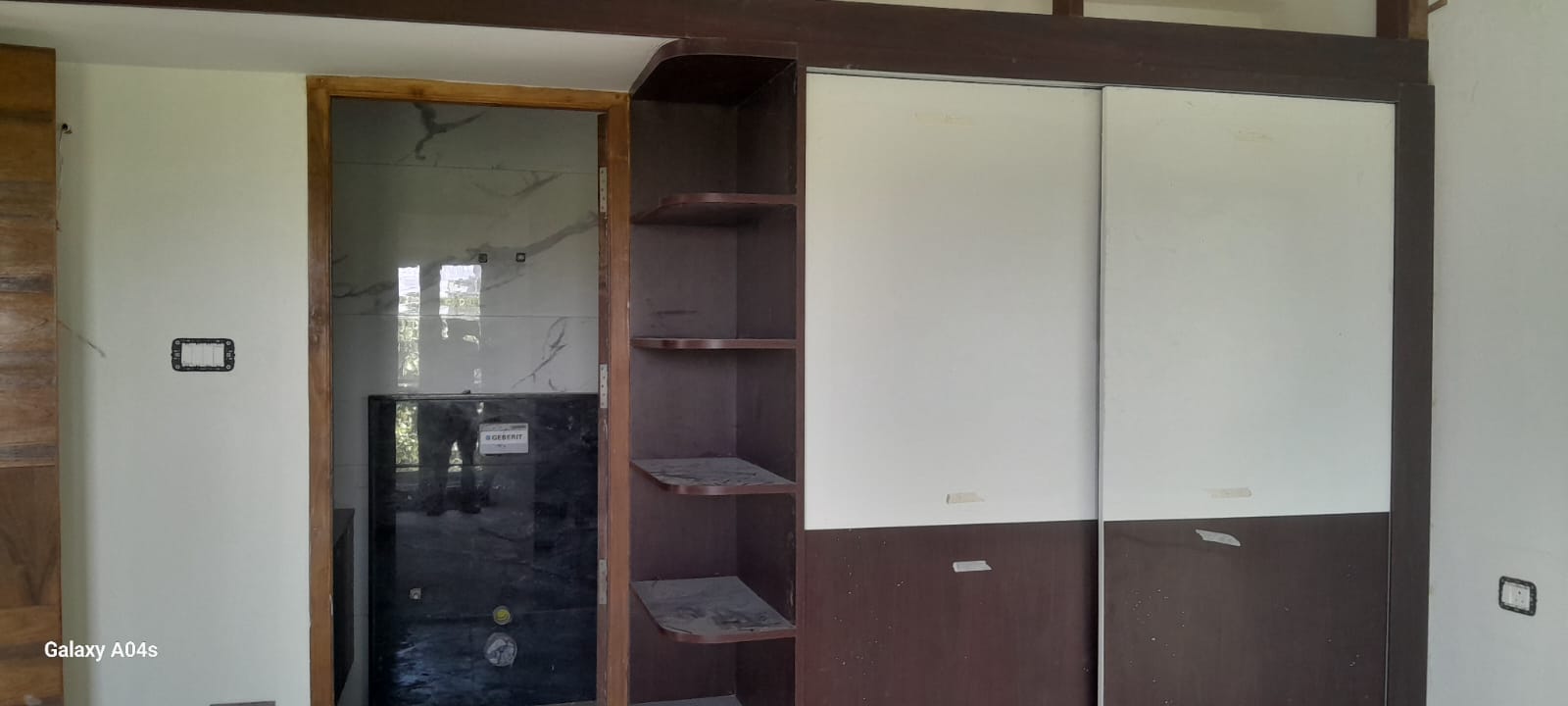

  • Wood work is in progress.(flat 1B progress)

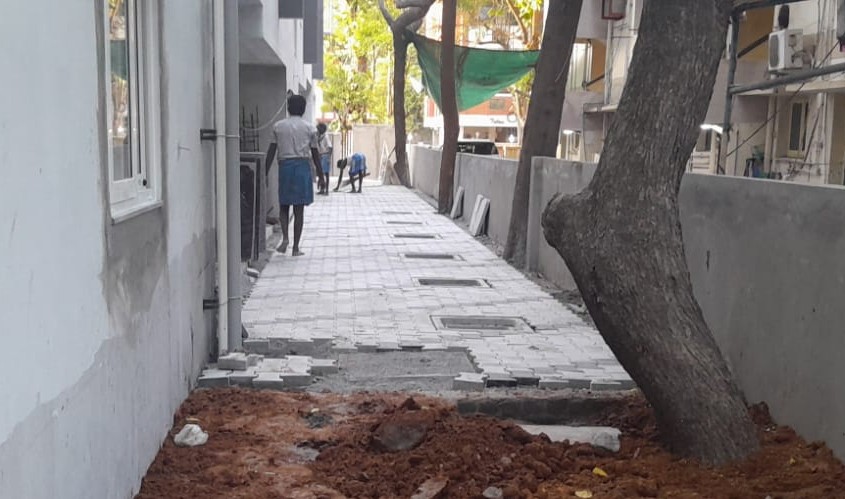

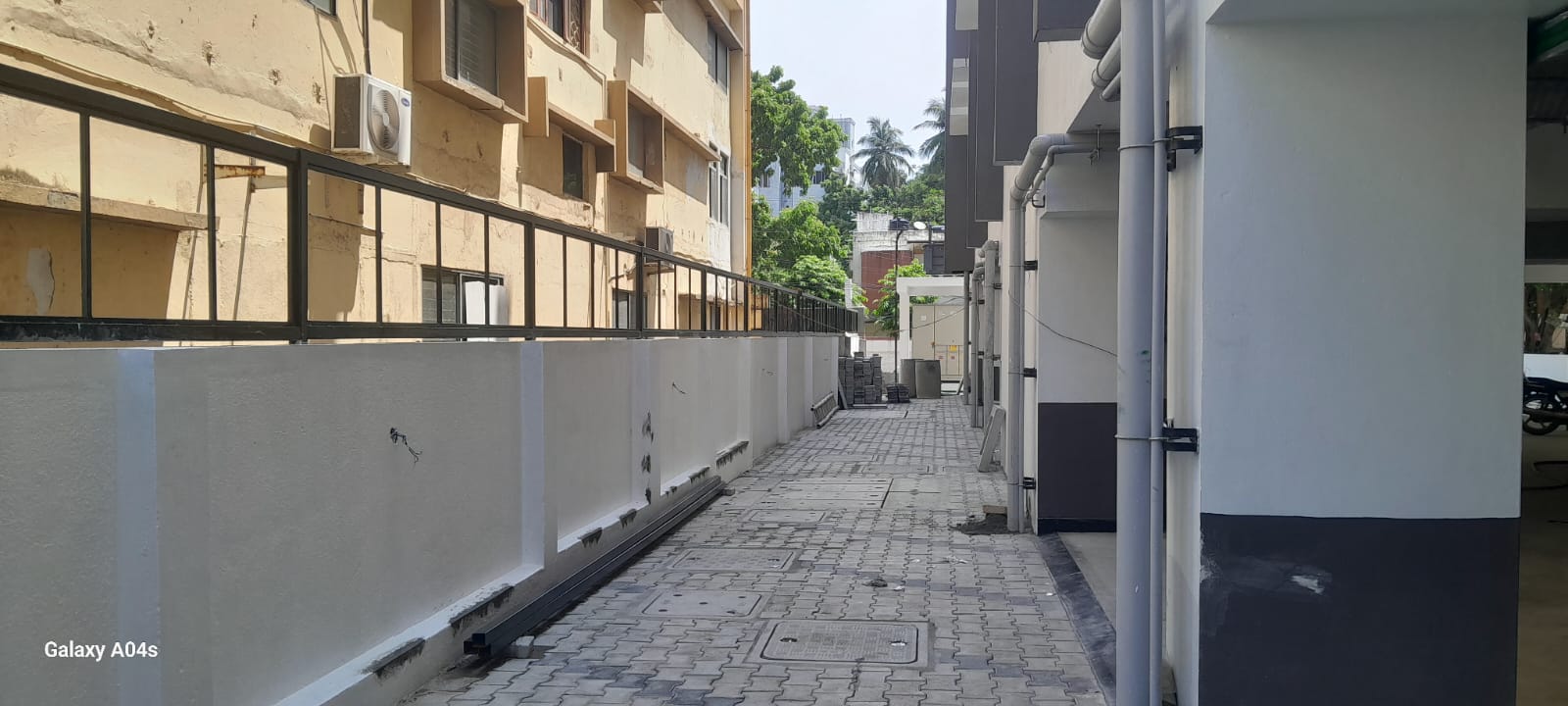

  • Paving block work is in progress.(90% completed)

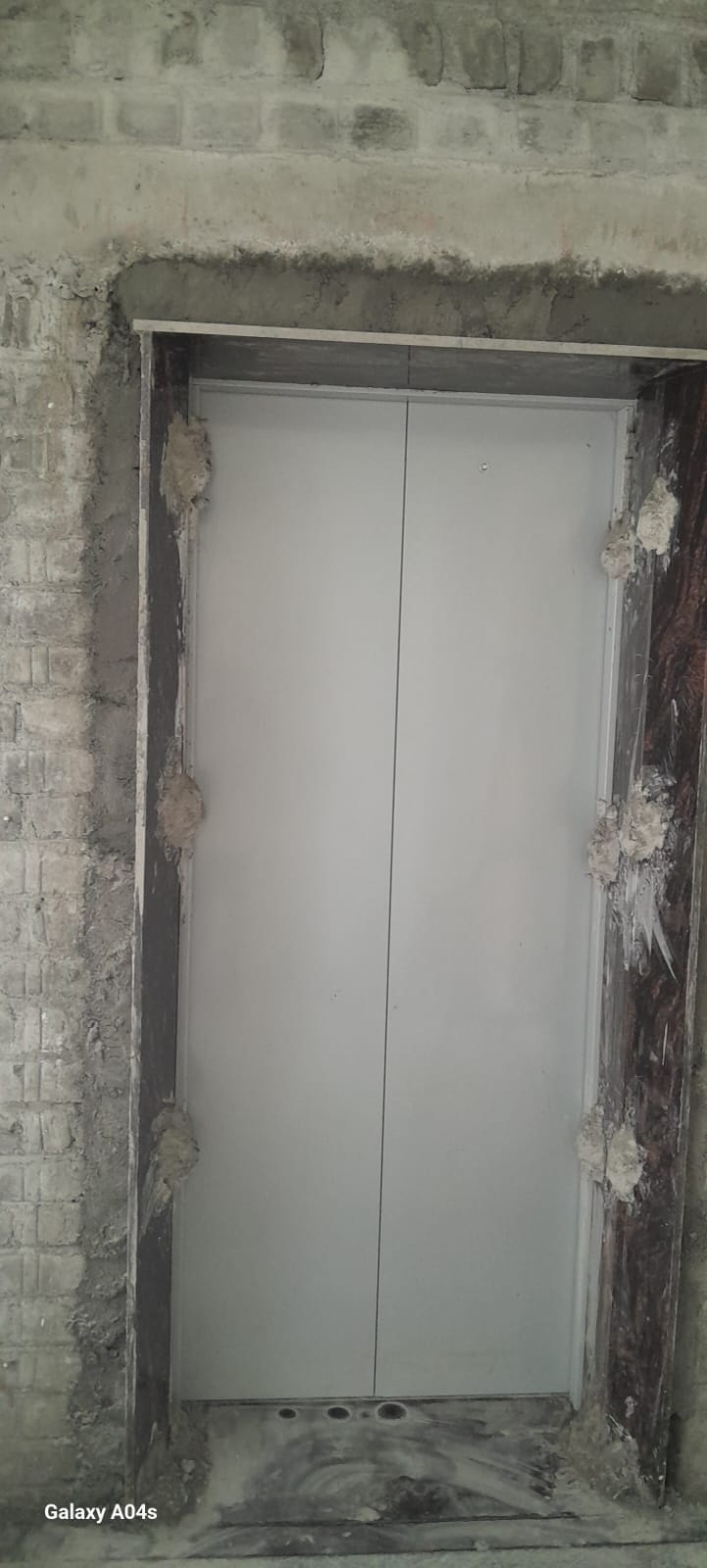

  • Lift erection work is in progress.(90% completed)

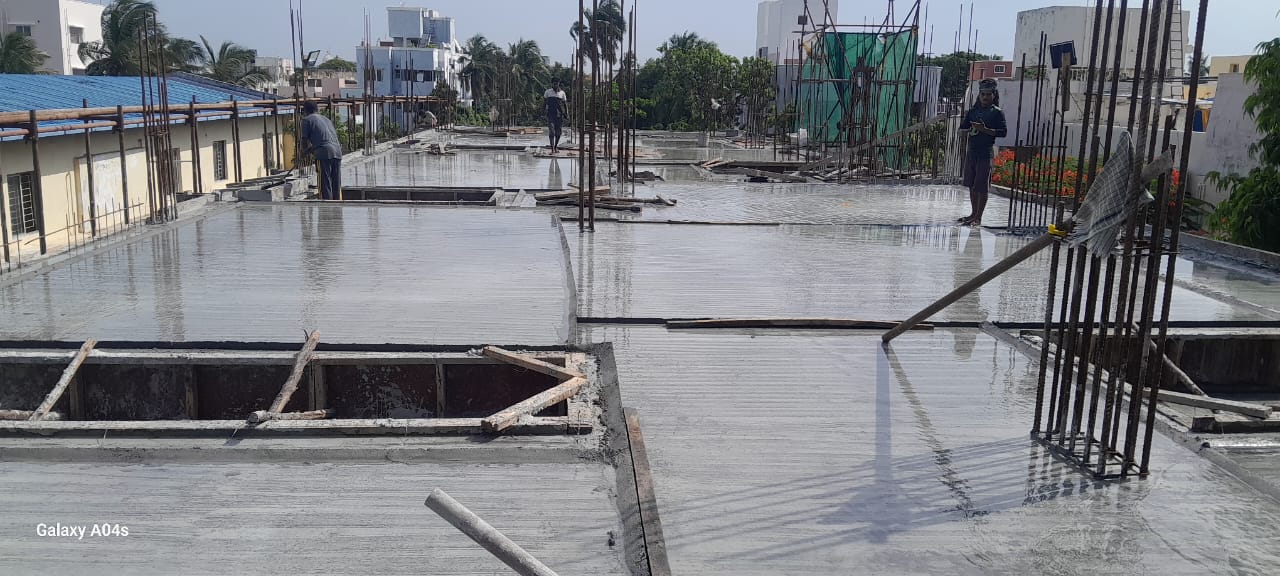

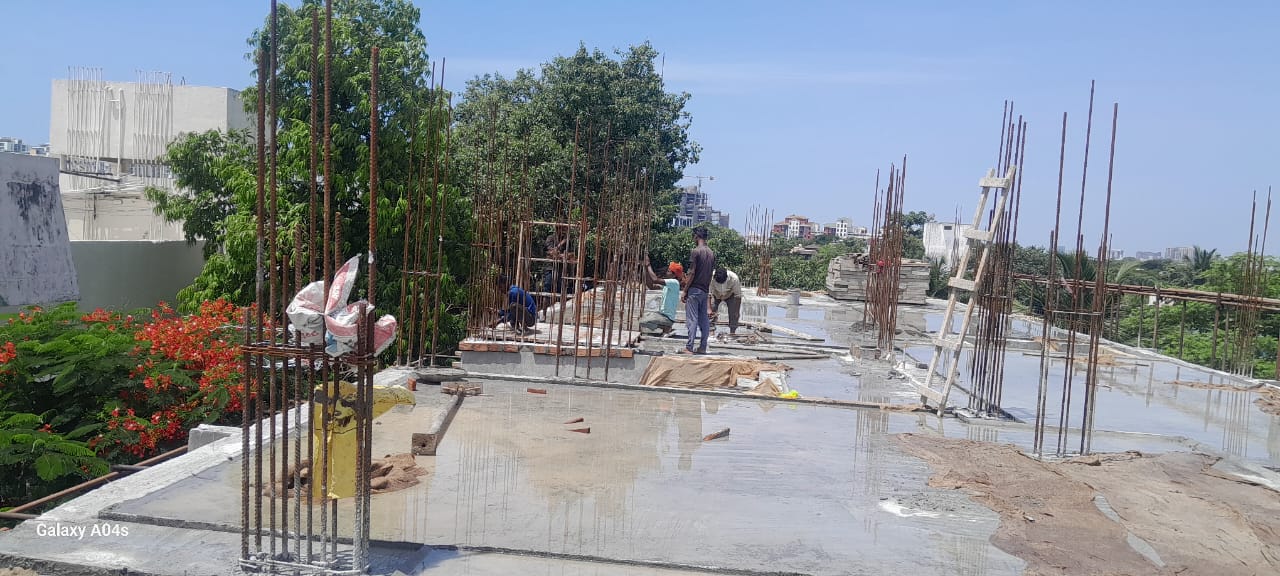

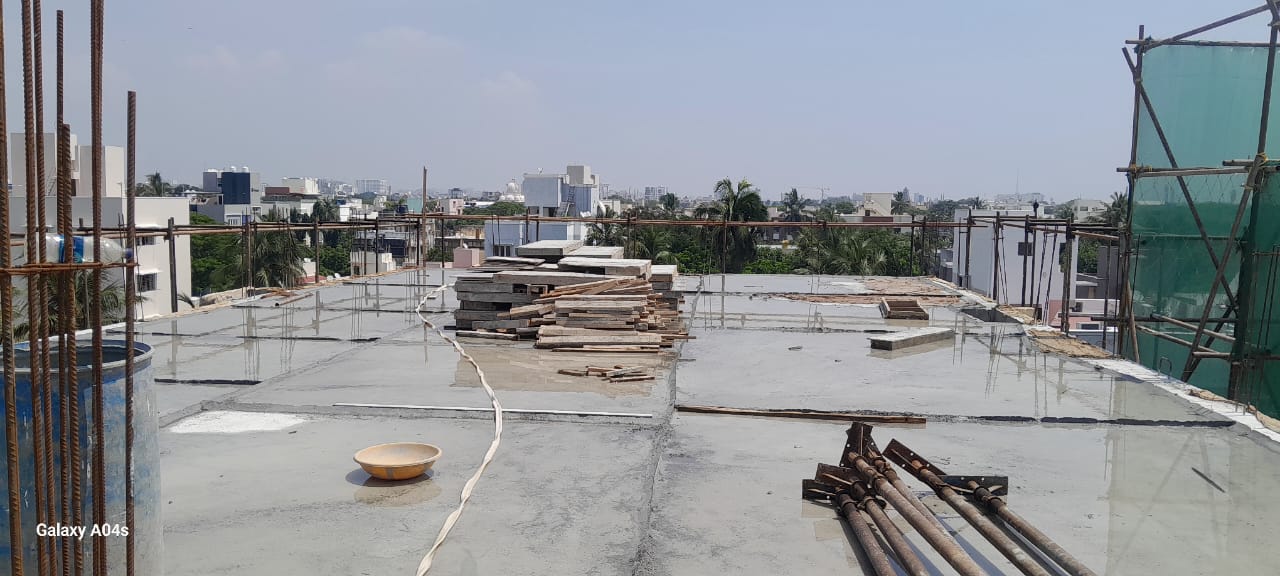

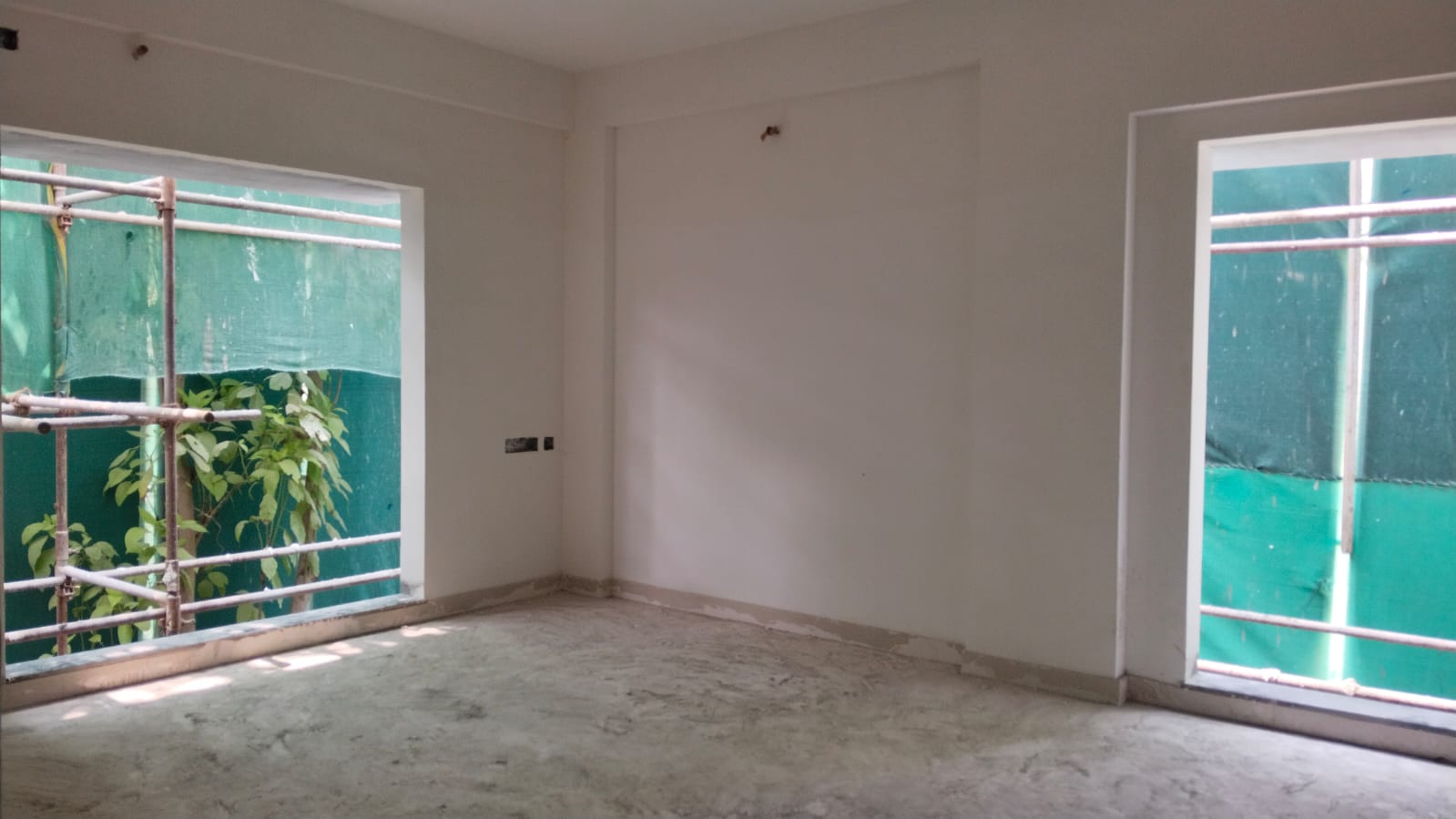

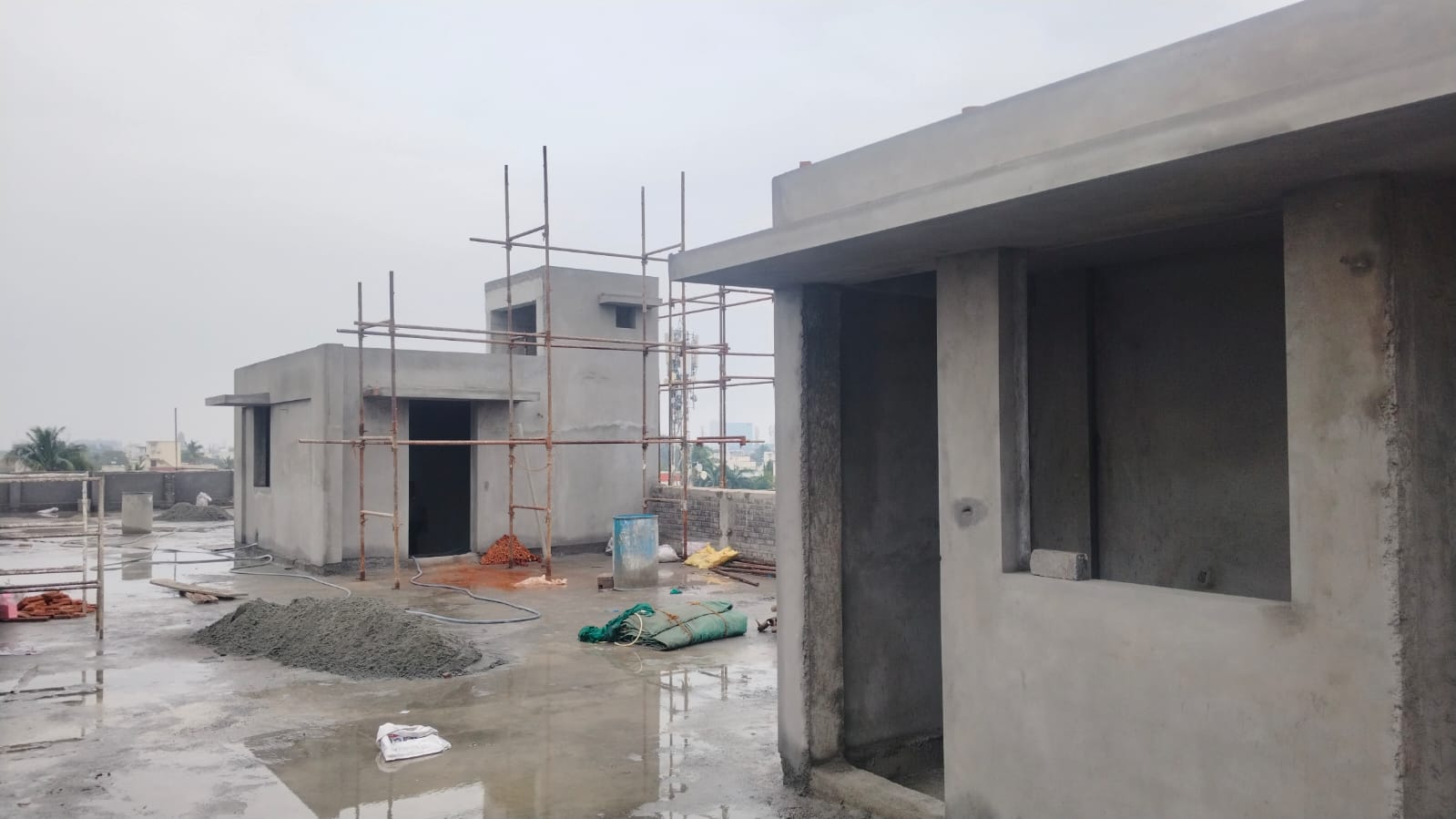

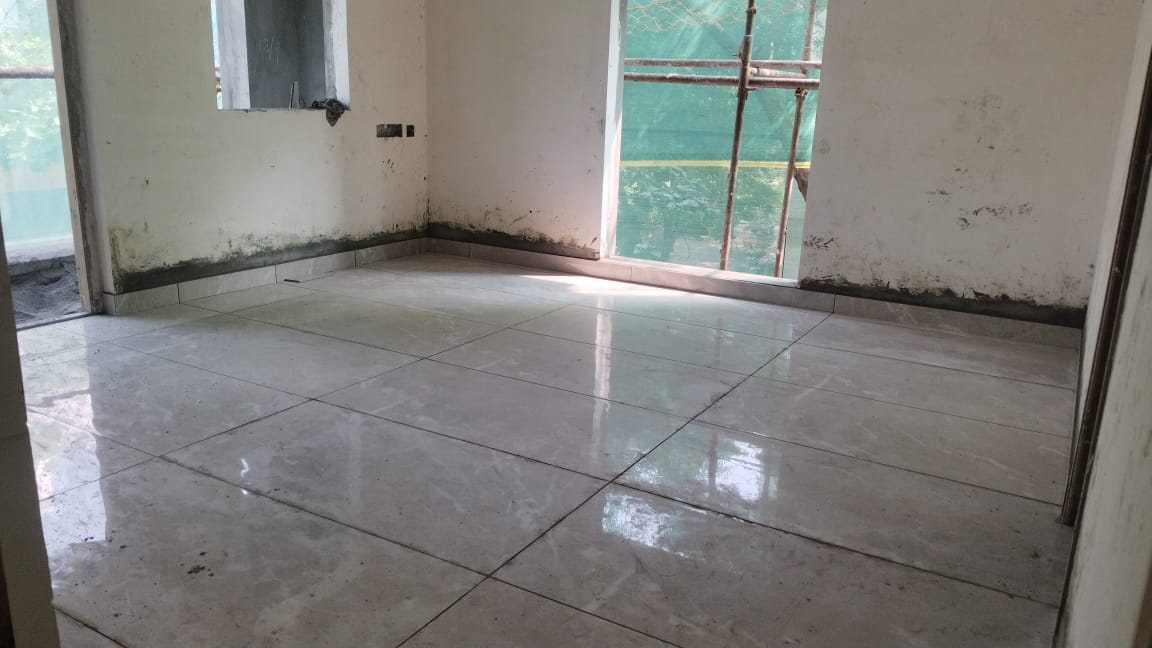

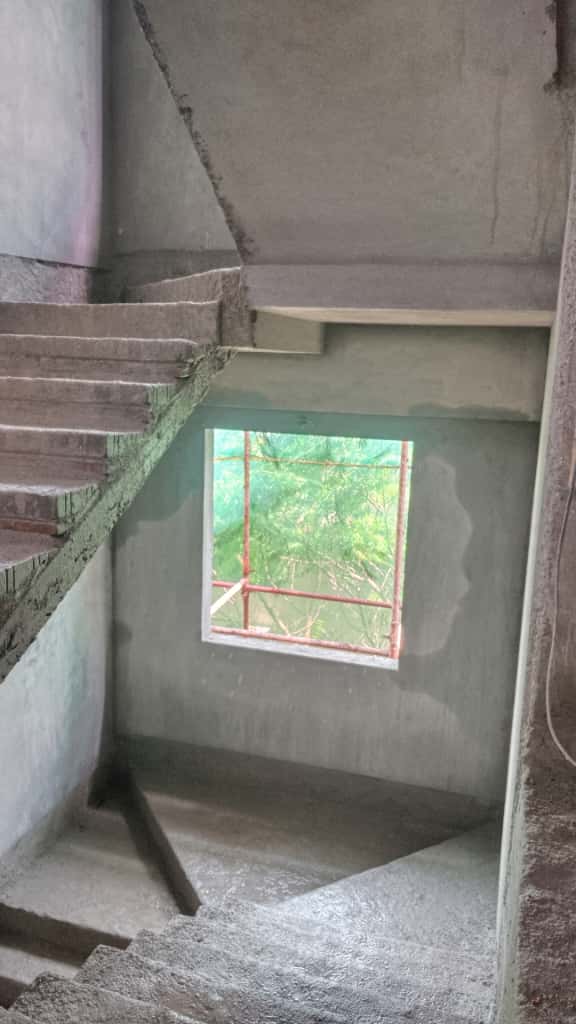

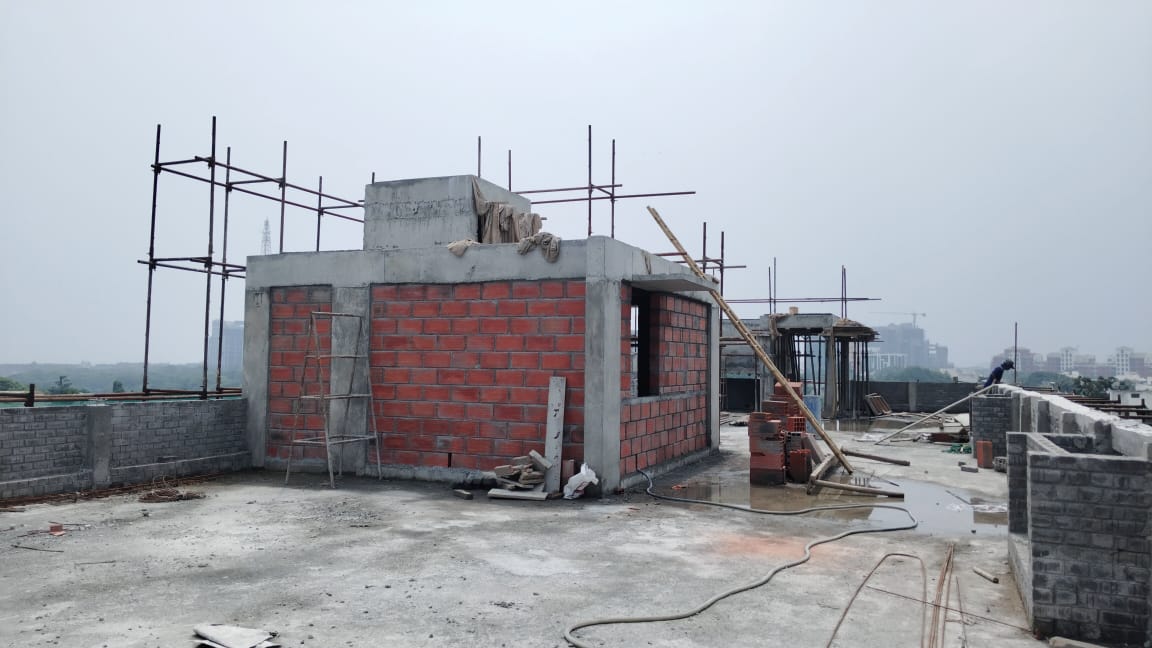

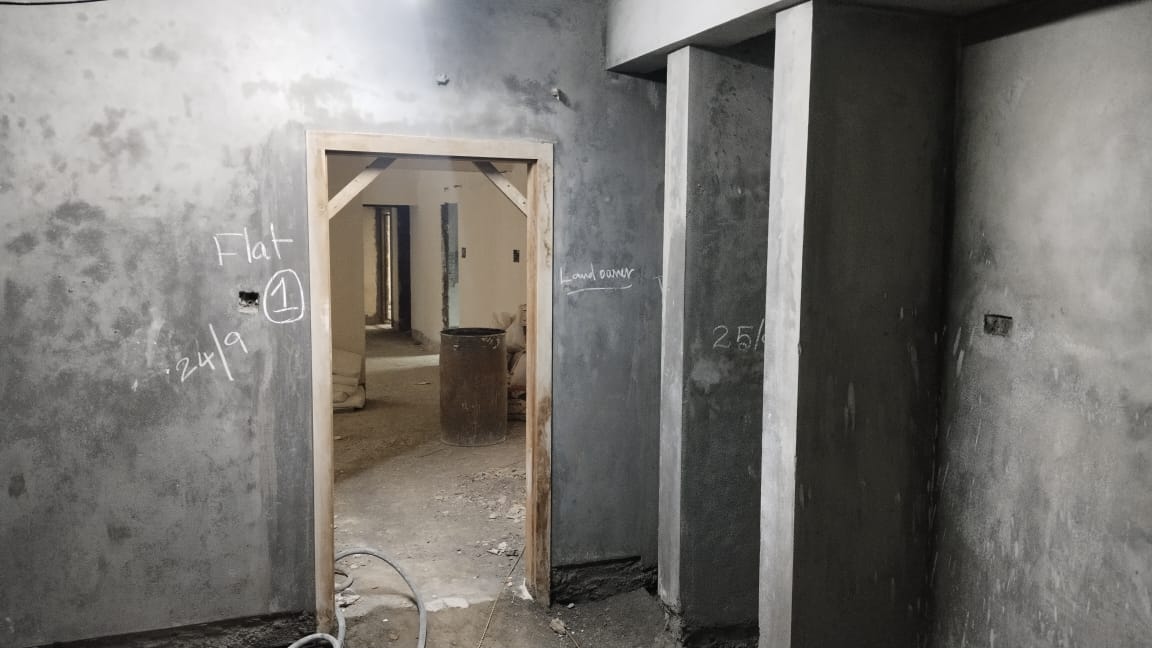

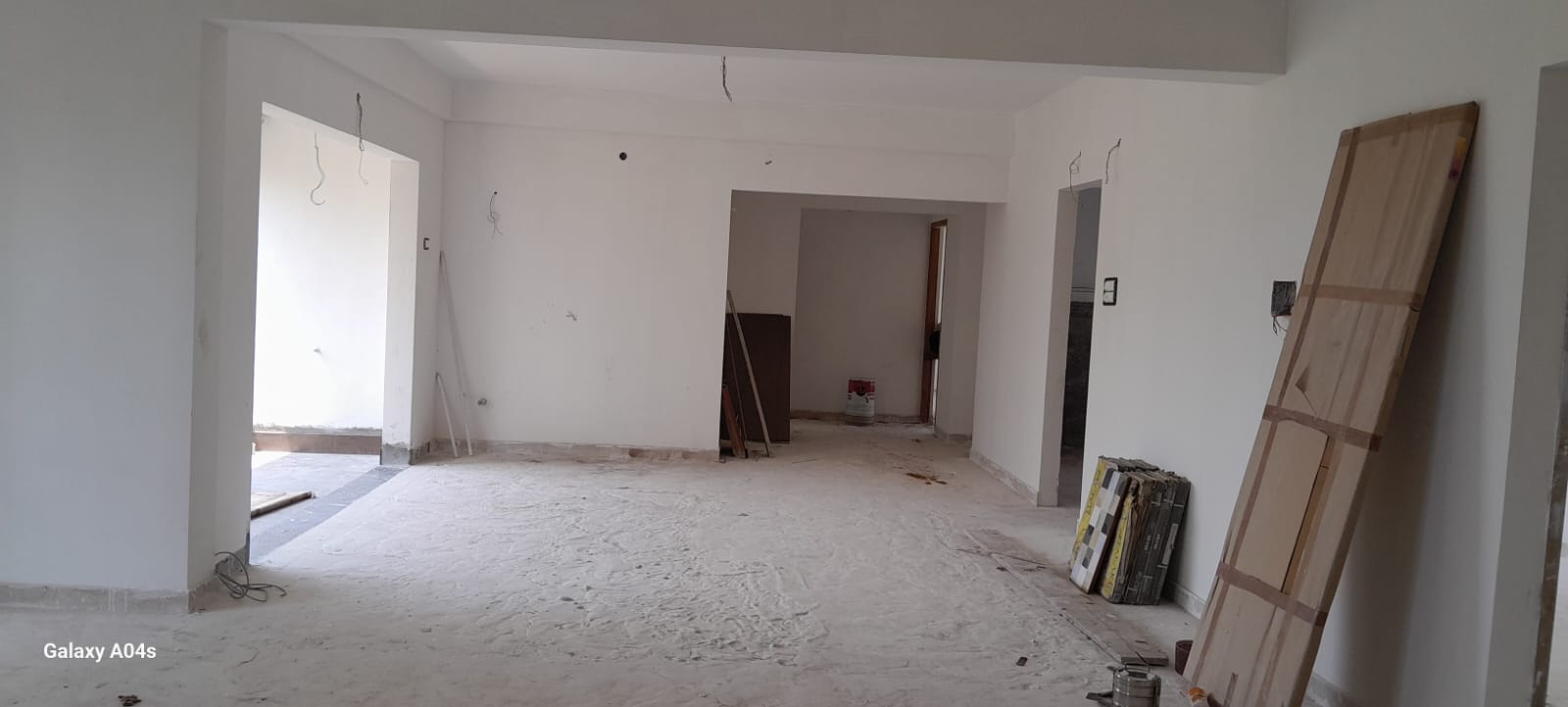

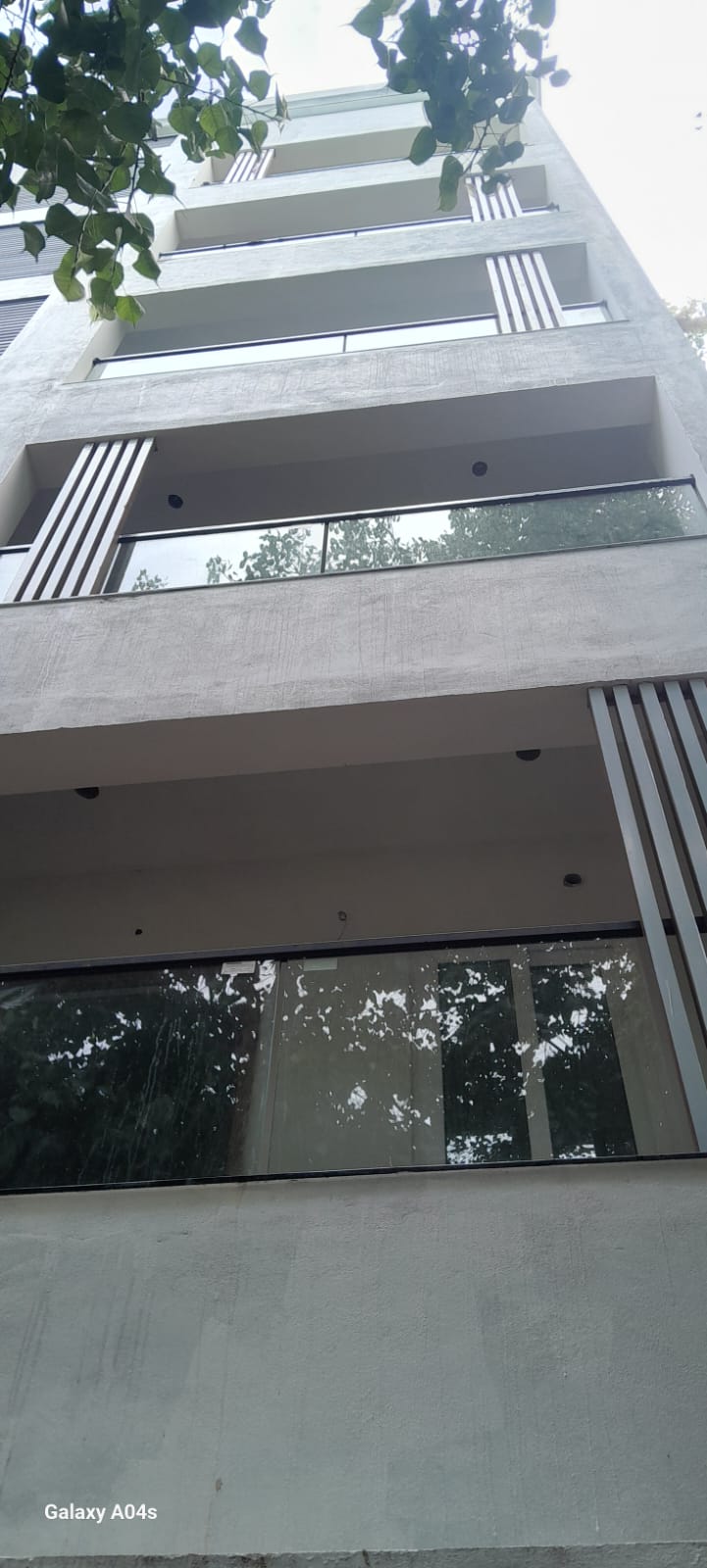

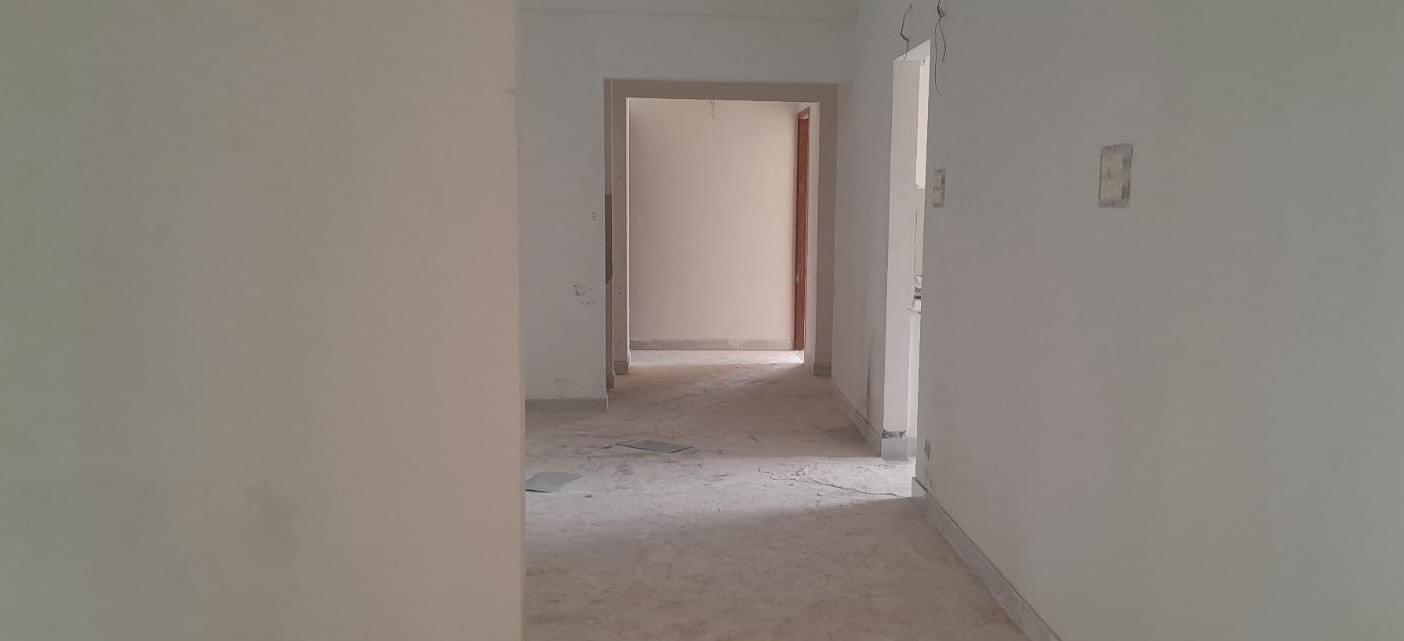

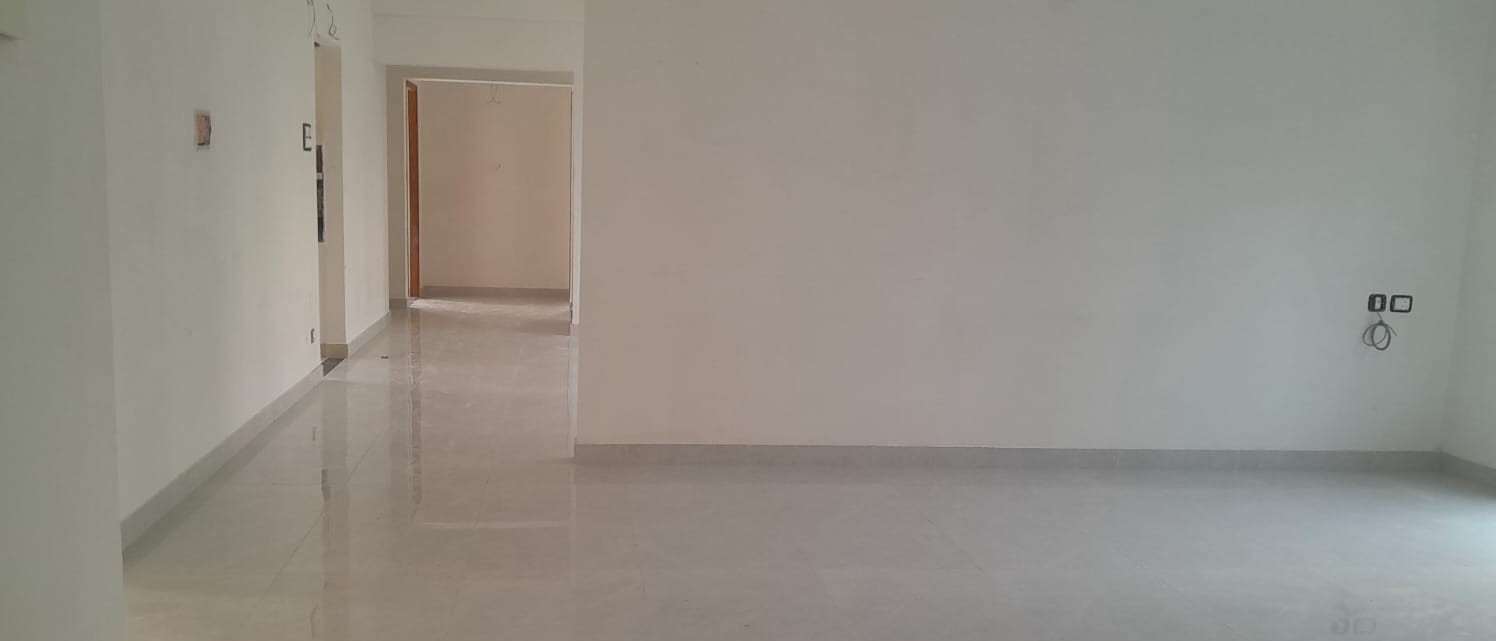

  • General flooring work is completed.

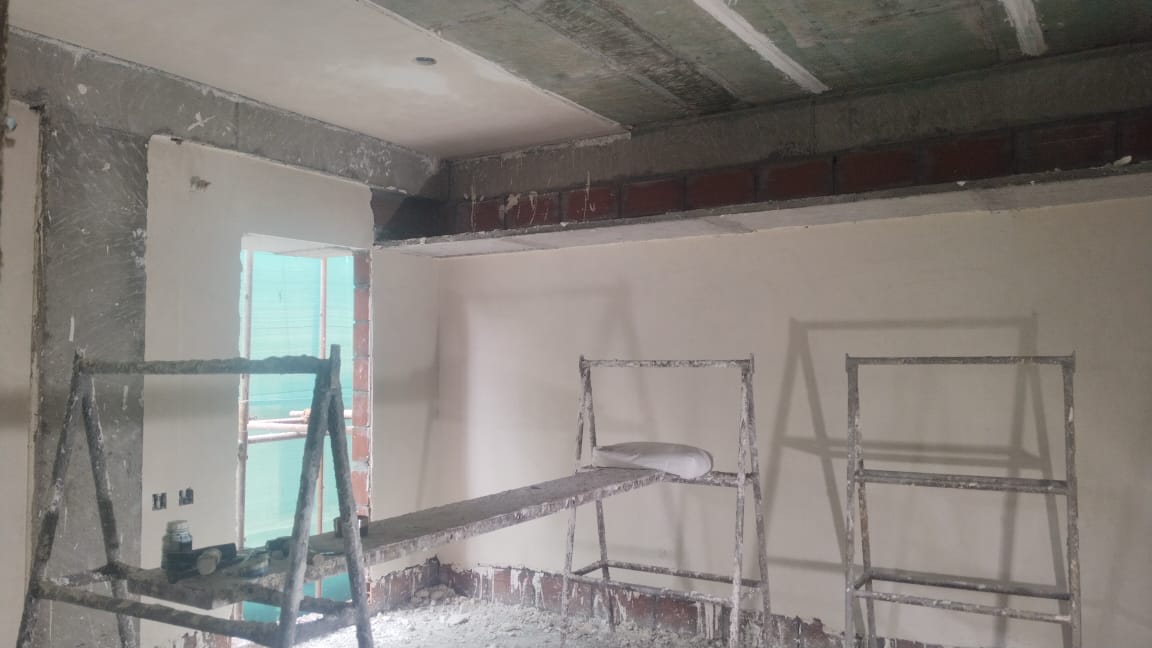

  • Inner putty work is in progress. (up to 4th floor completed,5th floor 50% completed)
  • 5th Floor inner primer work is in progress. (Up to 4th floor completed)

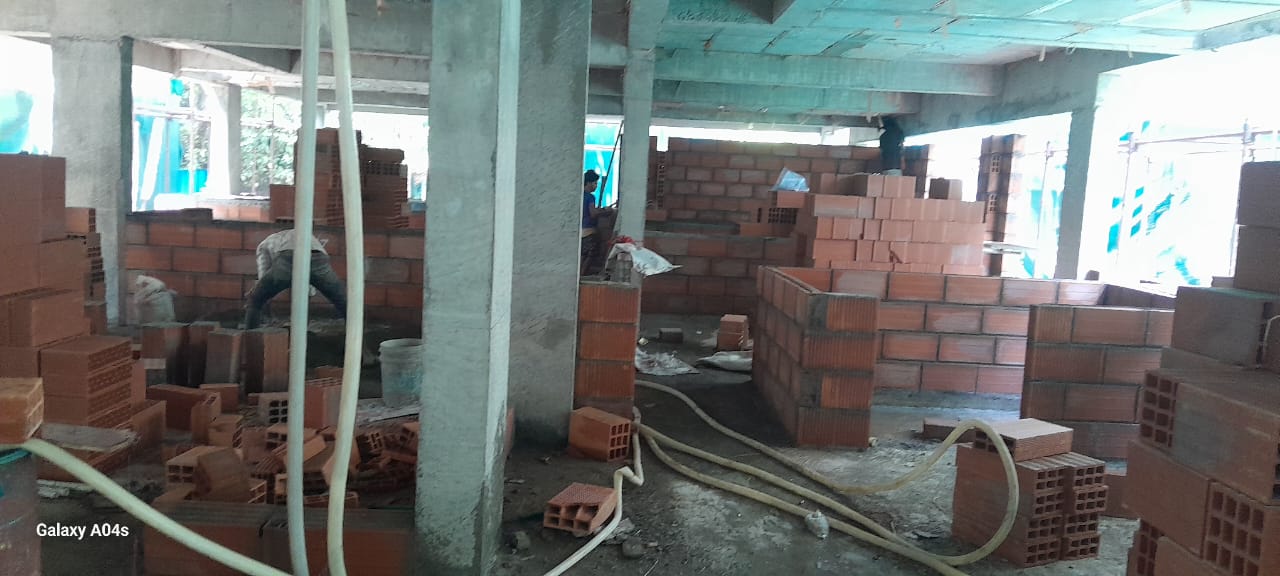

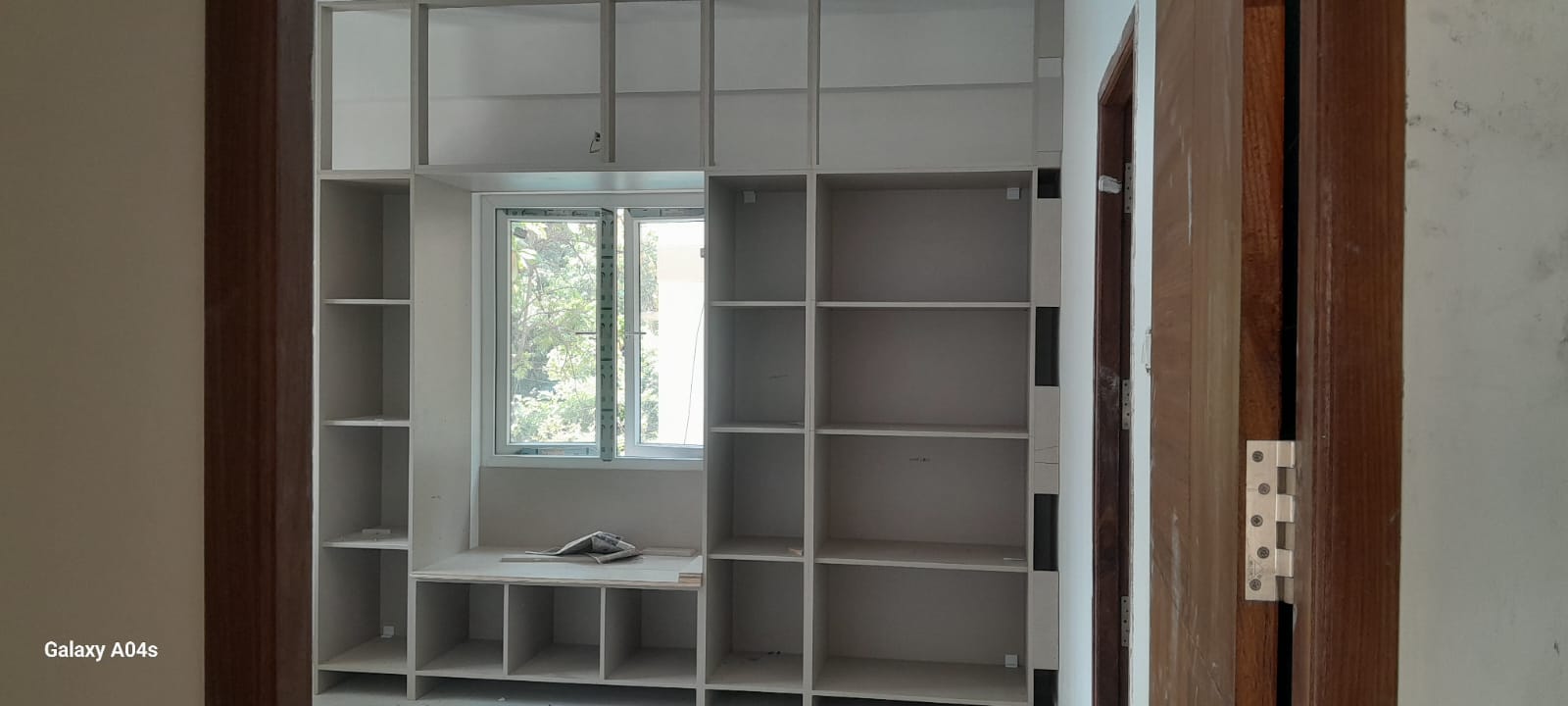

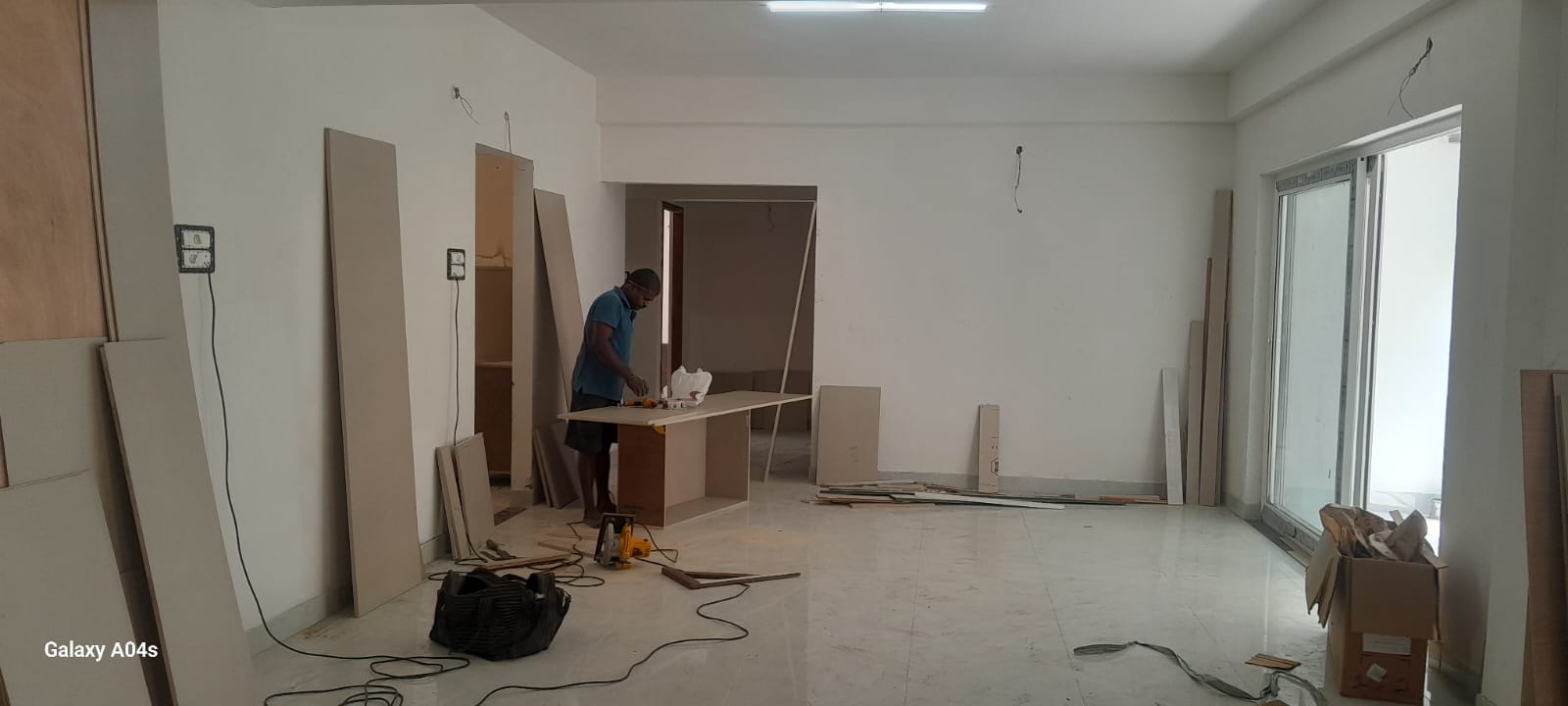

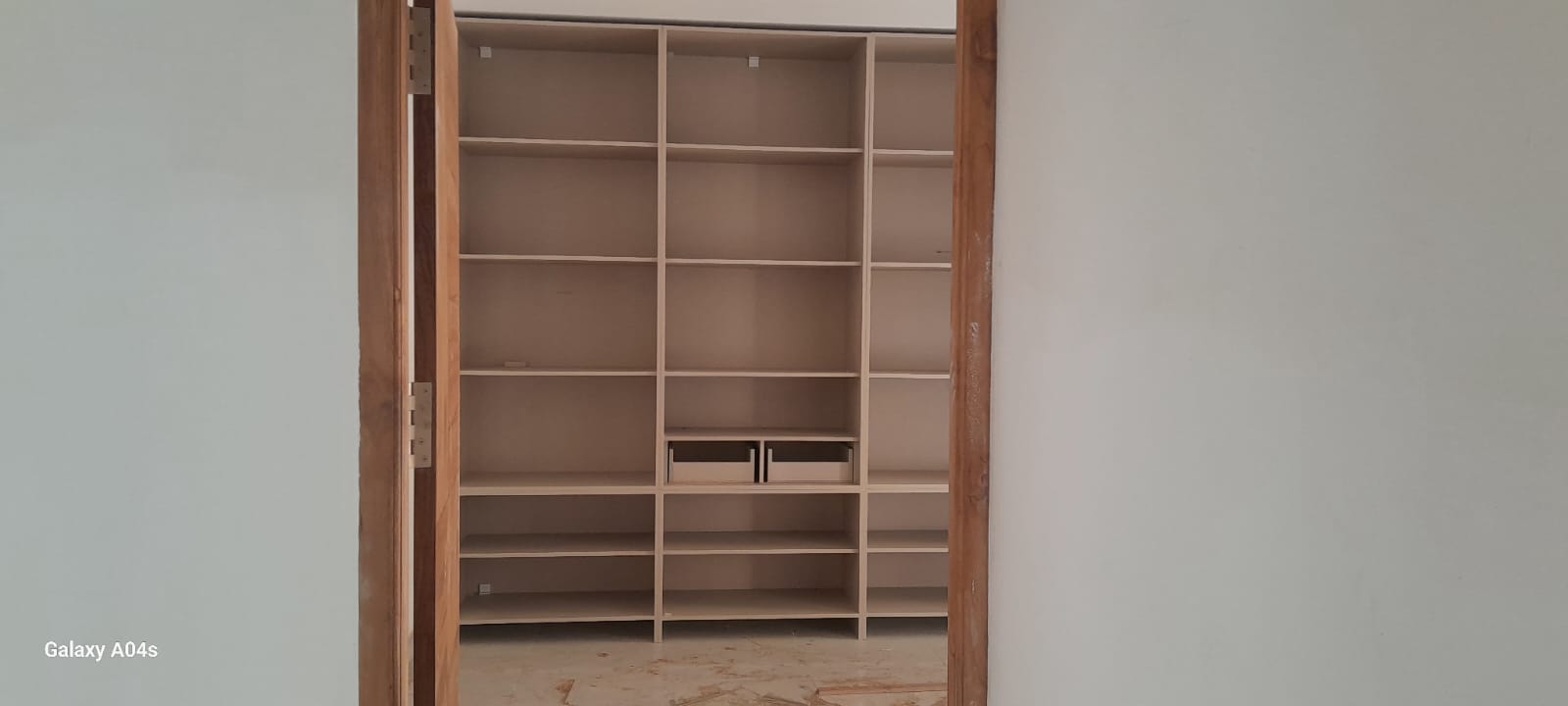

  • Wood work is in progress.(flat 1B progress)

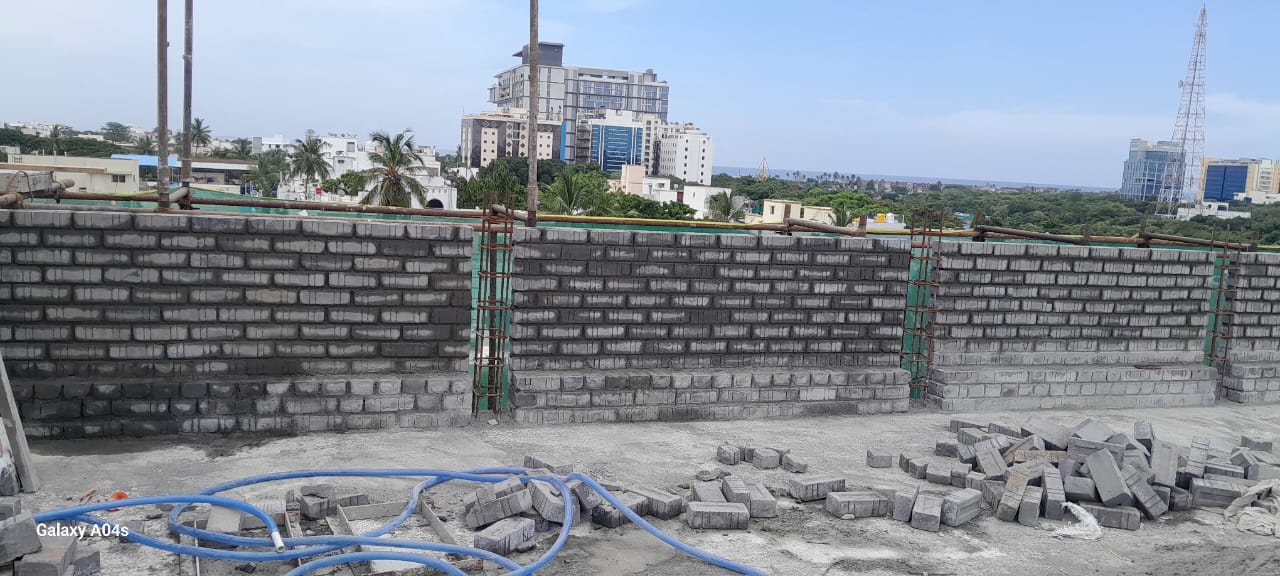

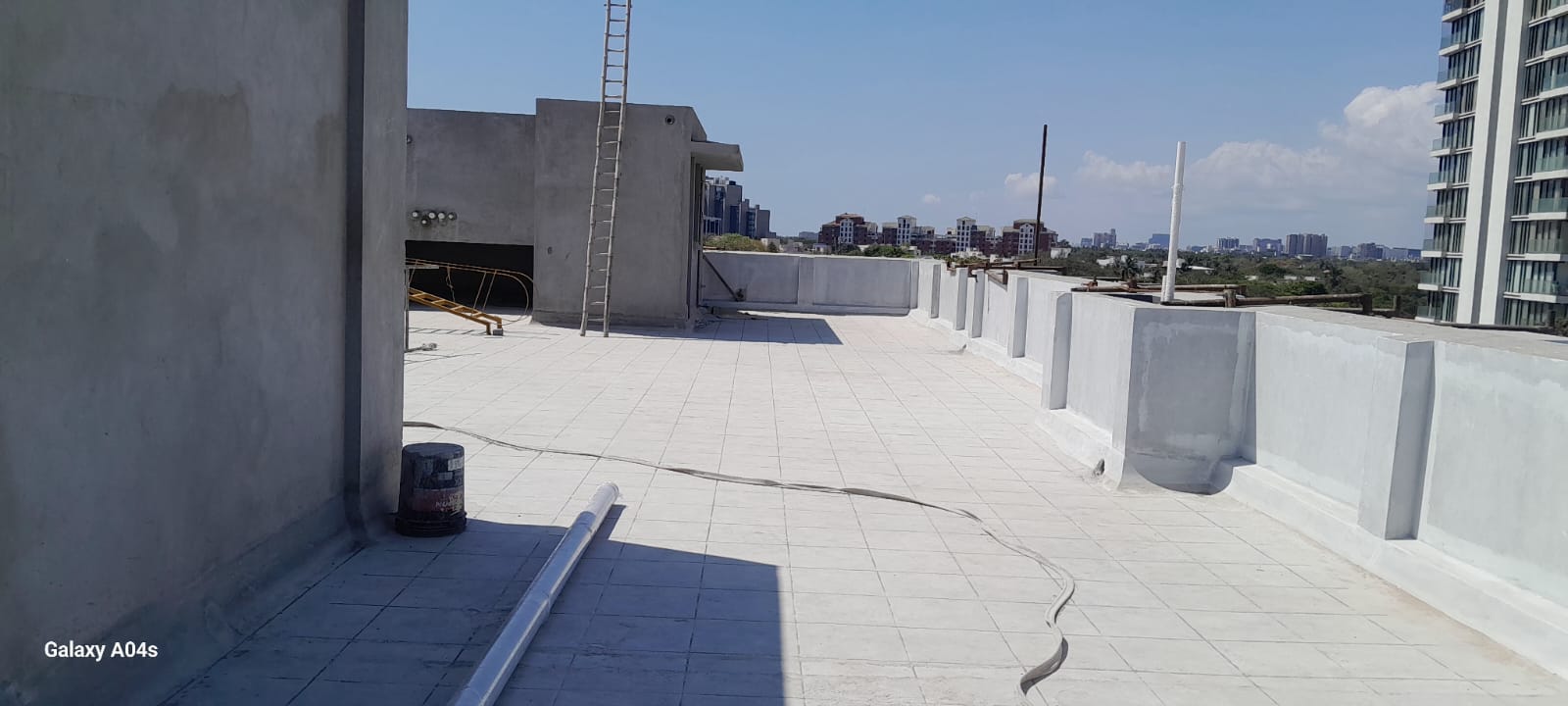

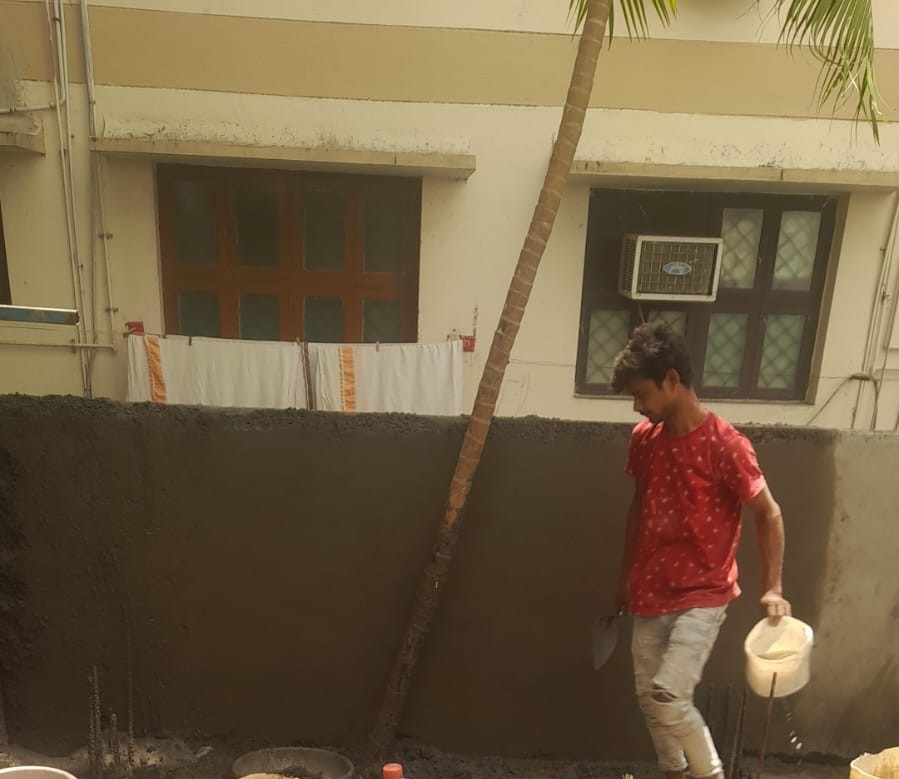

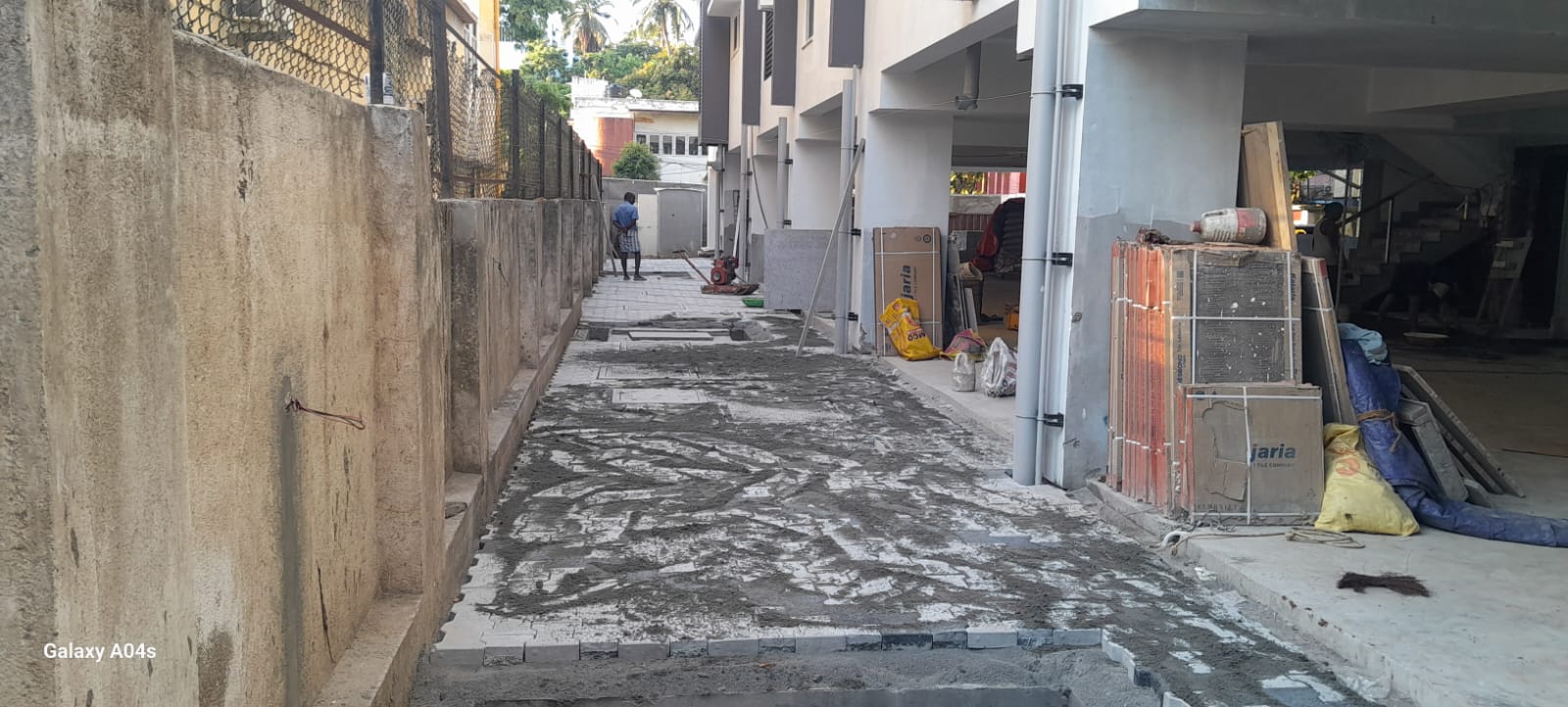

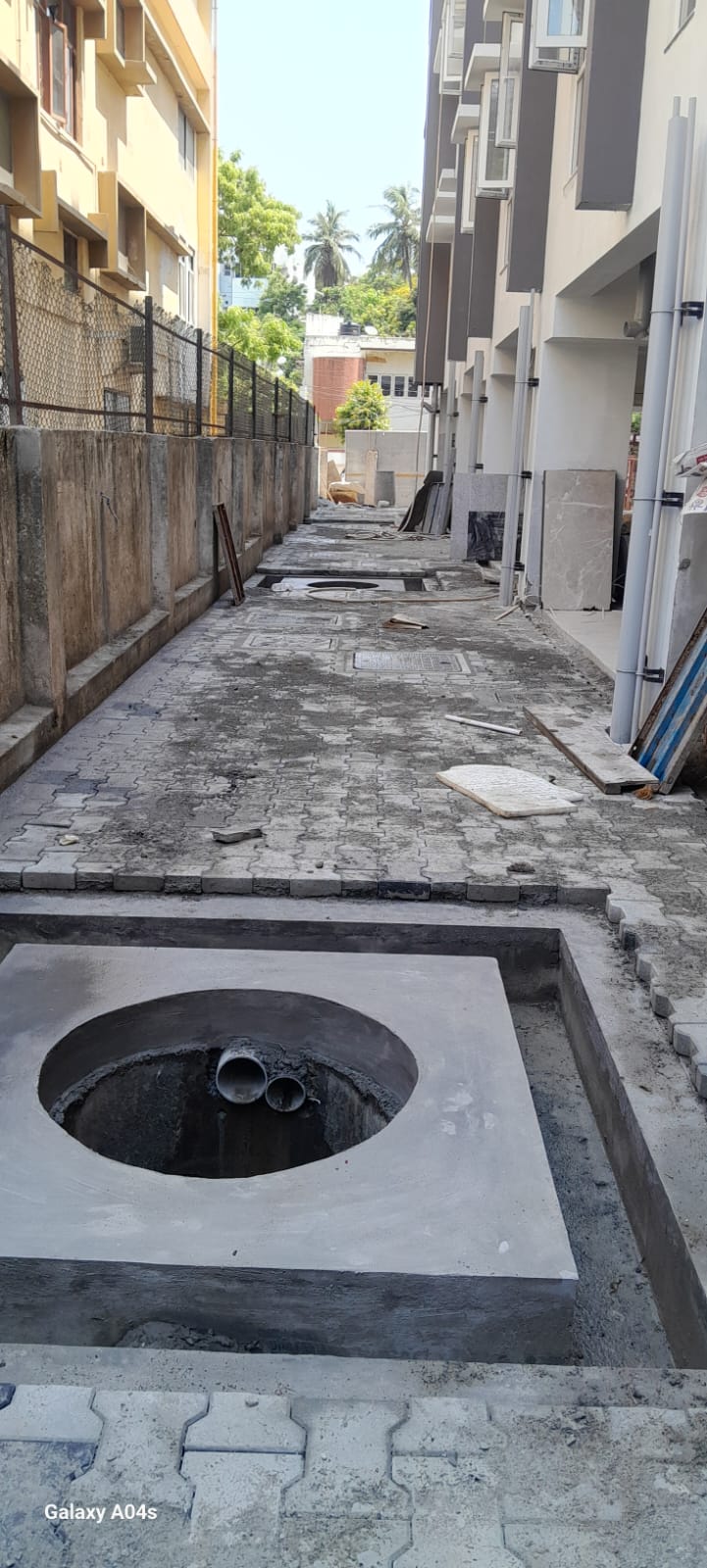

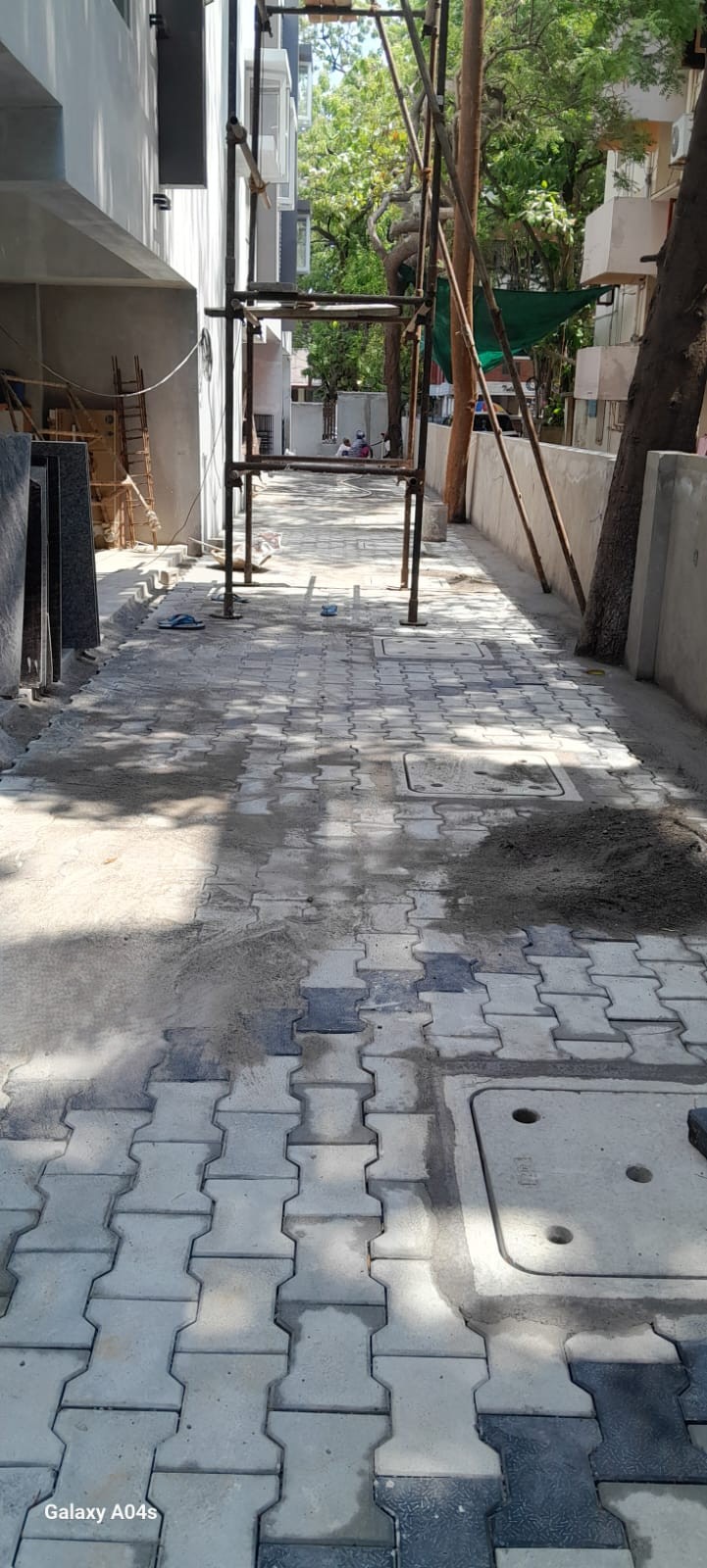

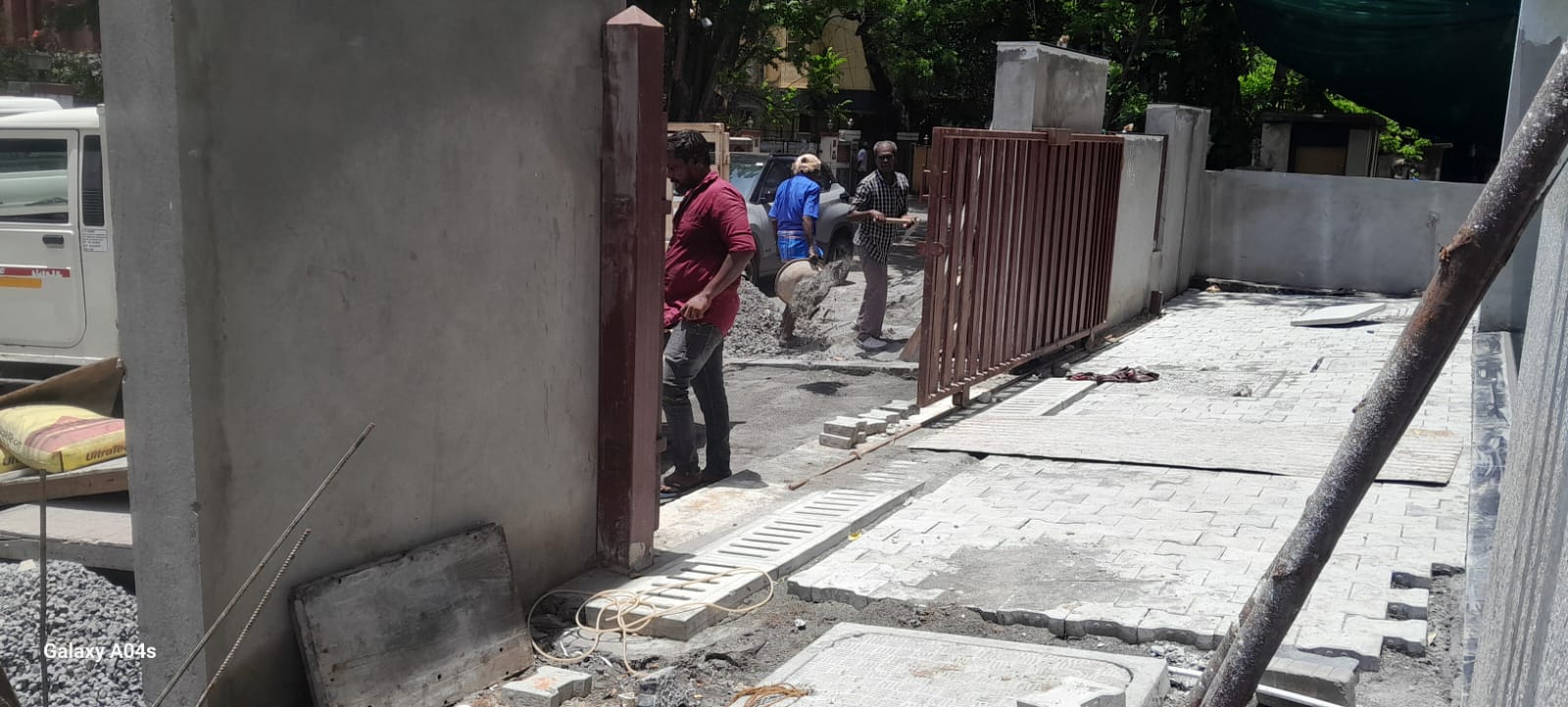

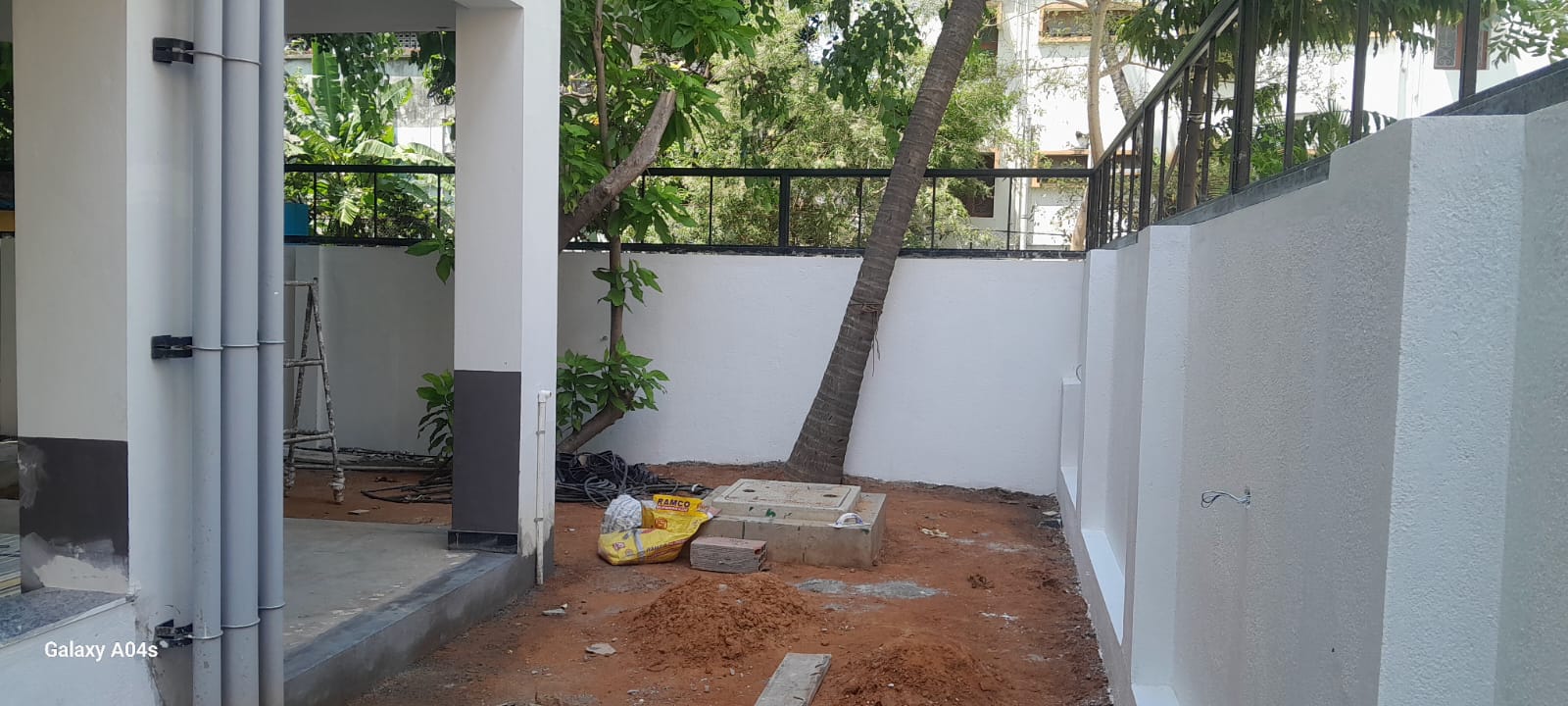

  • Paving block work is completed.

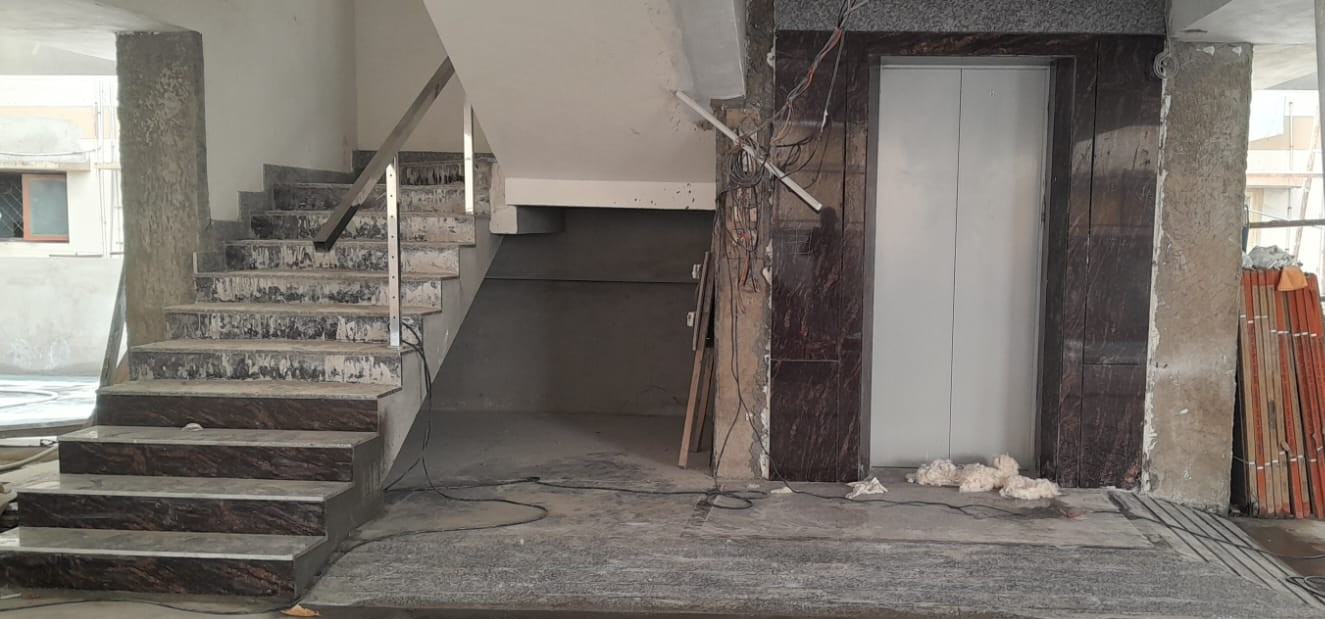

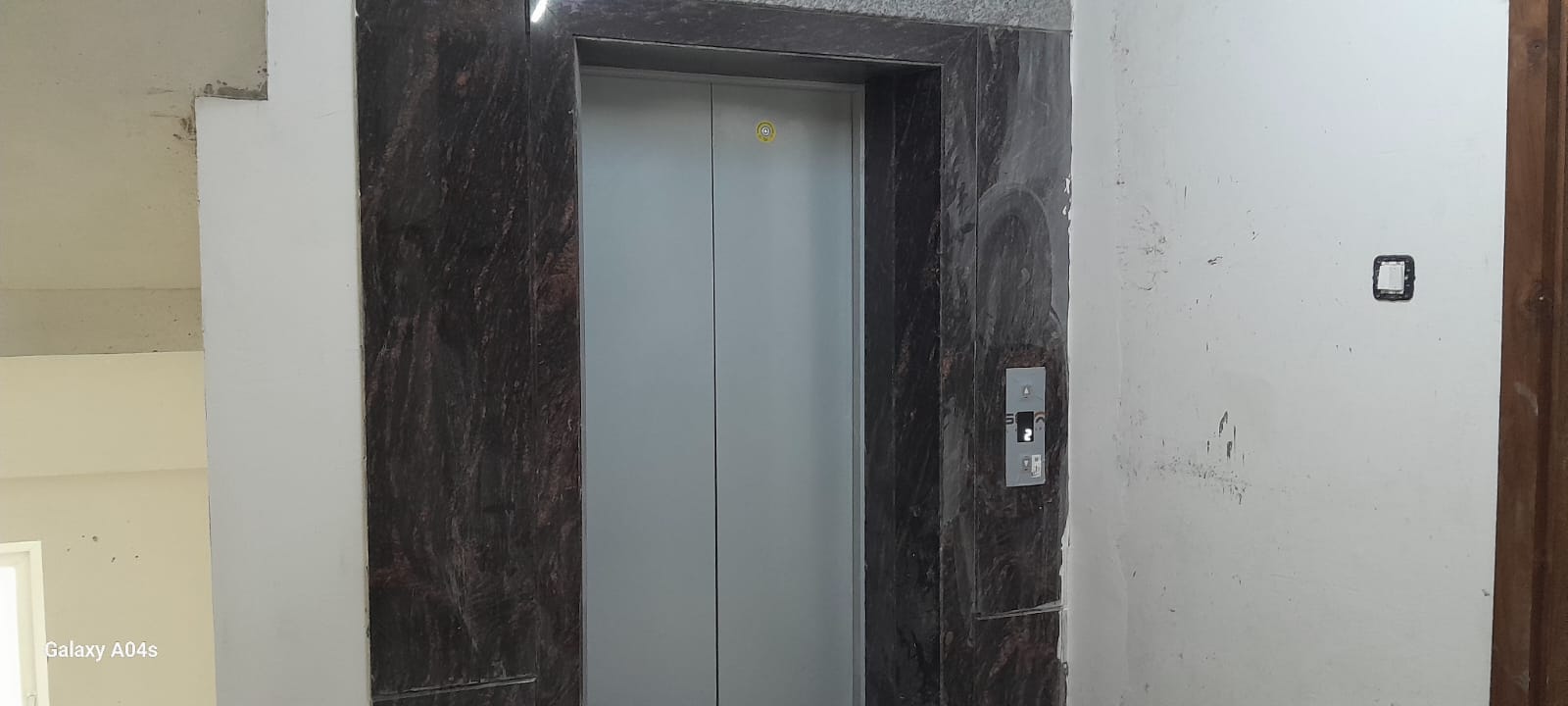

  • Lift erection work is completed.

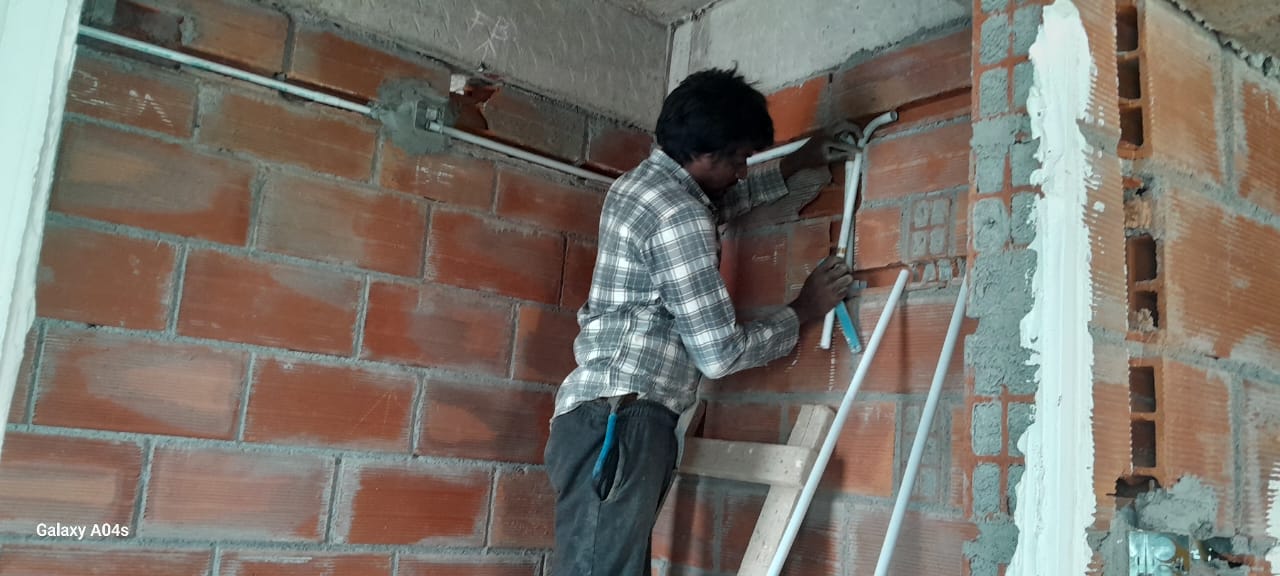

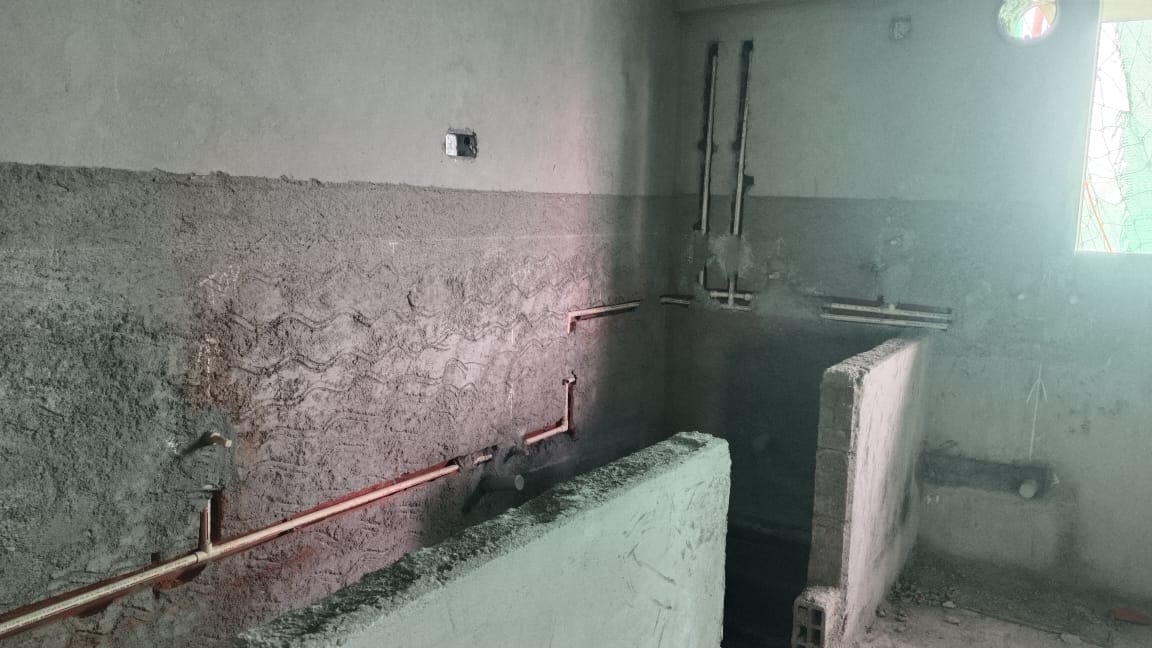

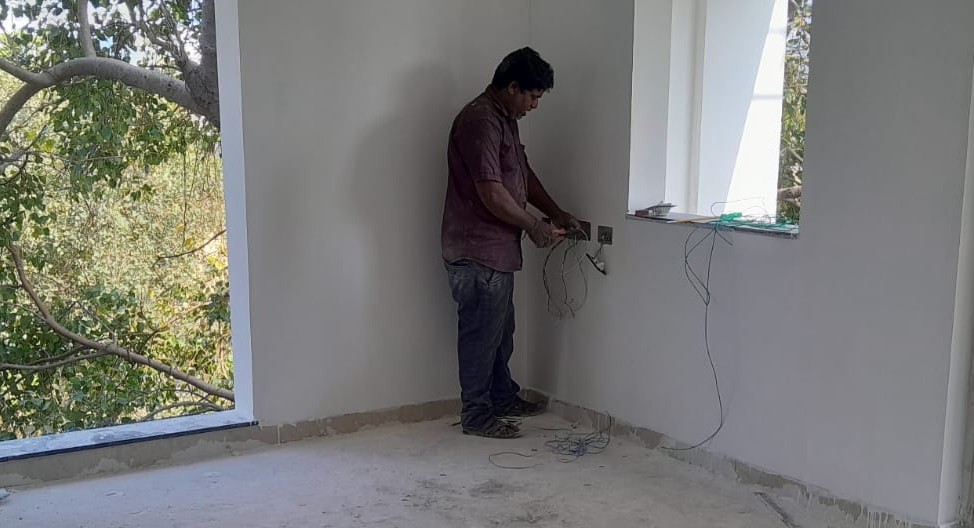

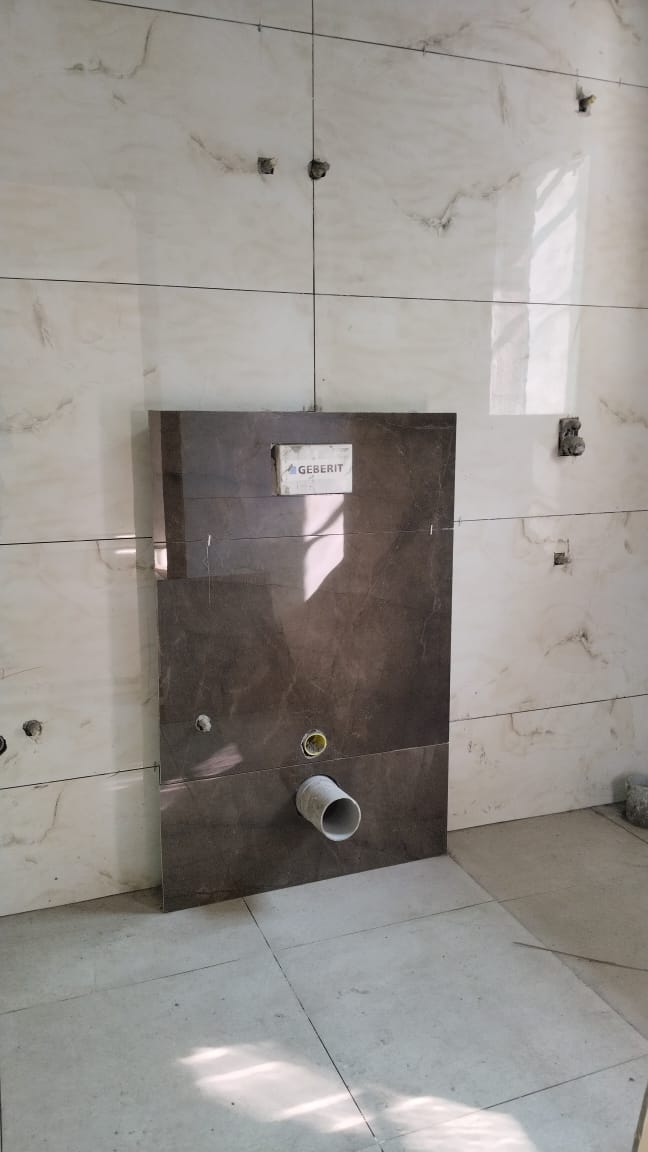

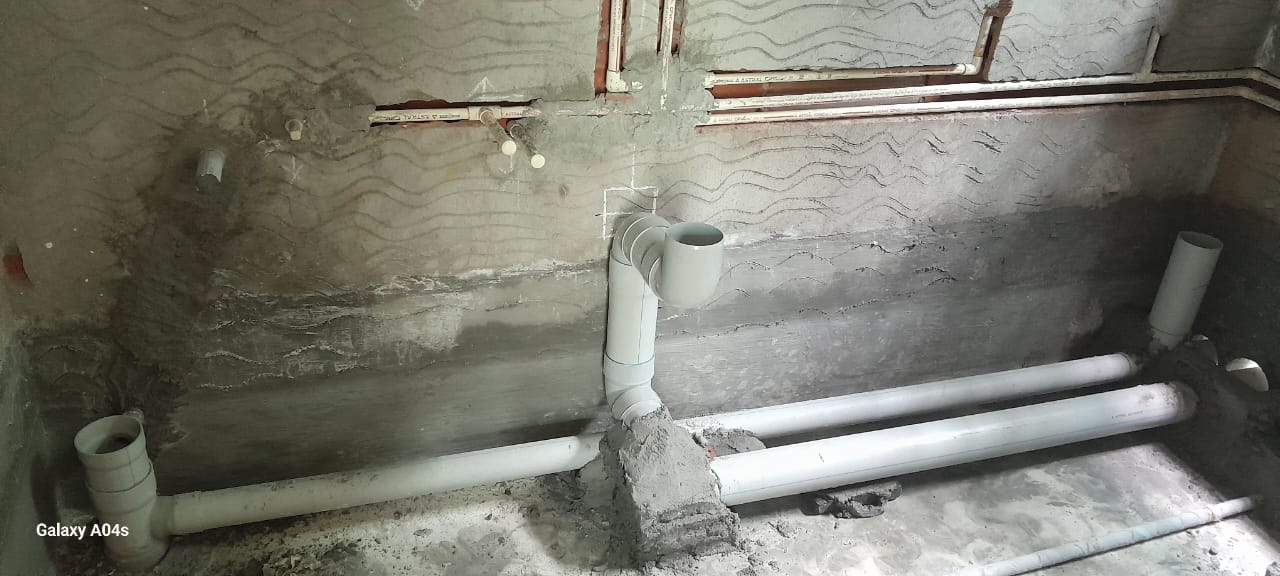

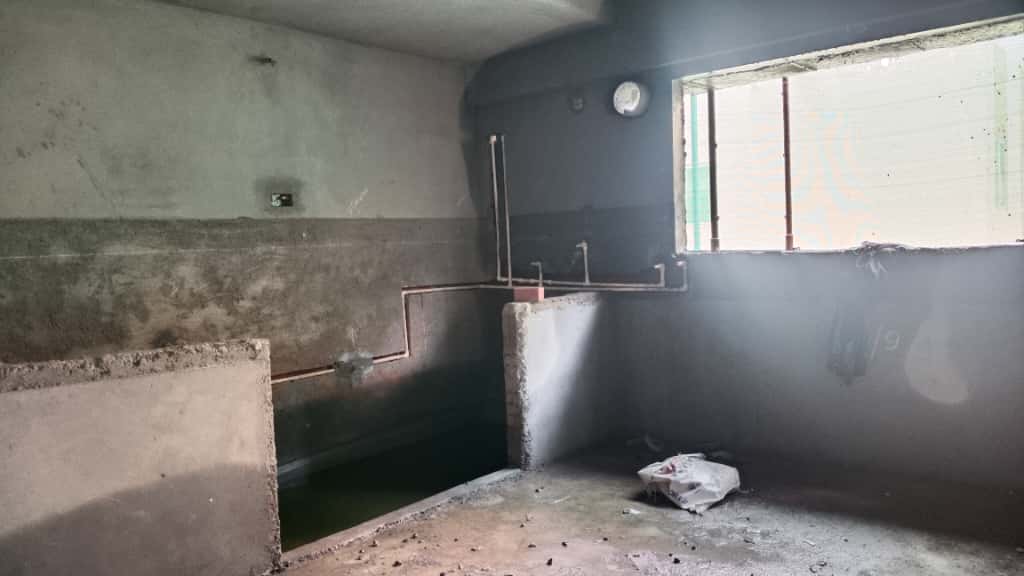

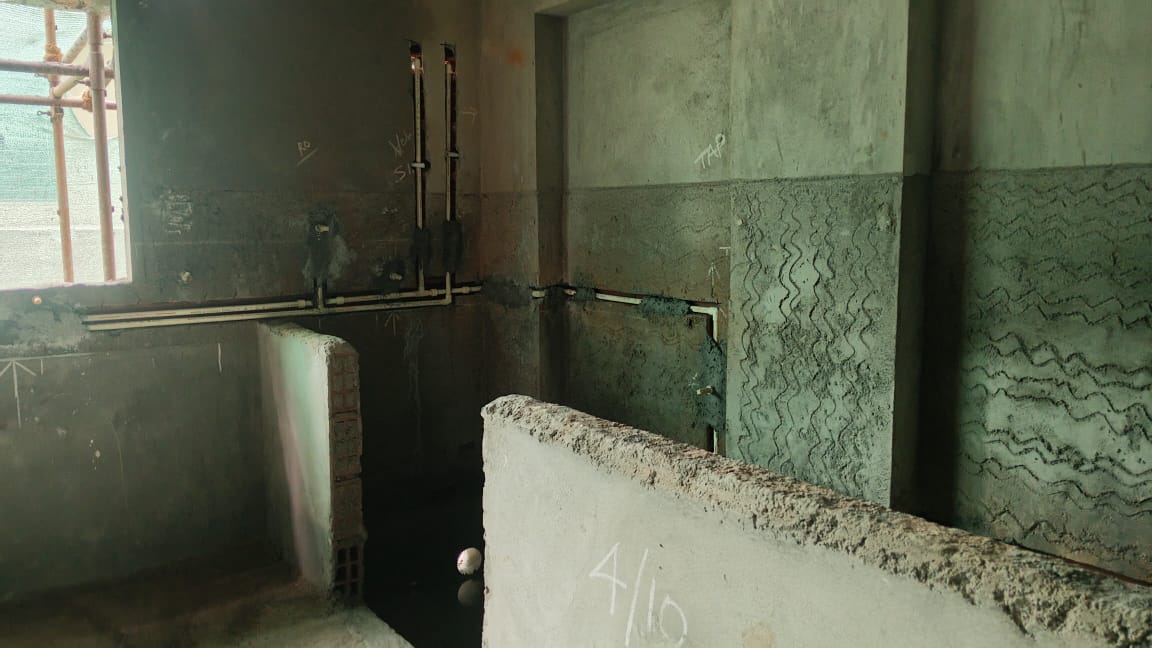

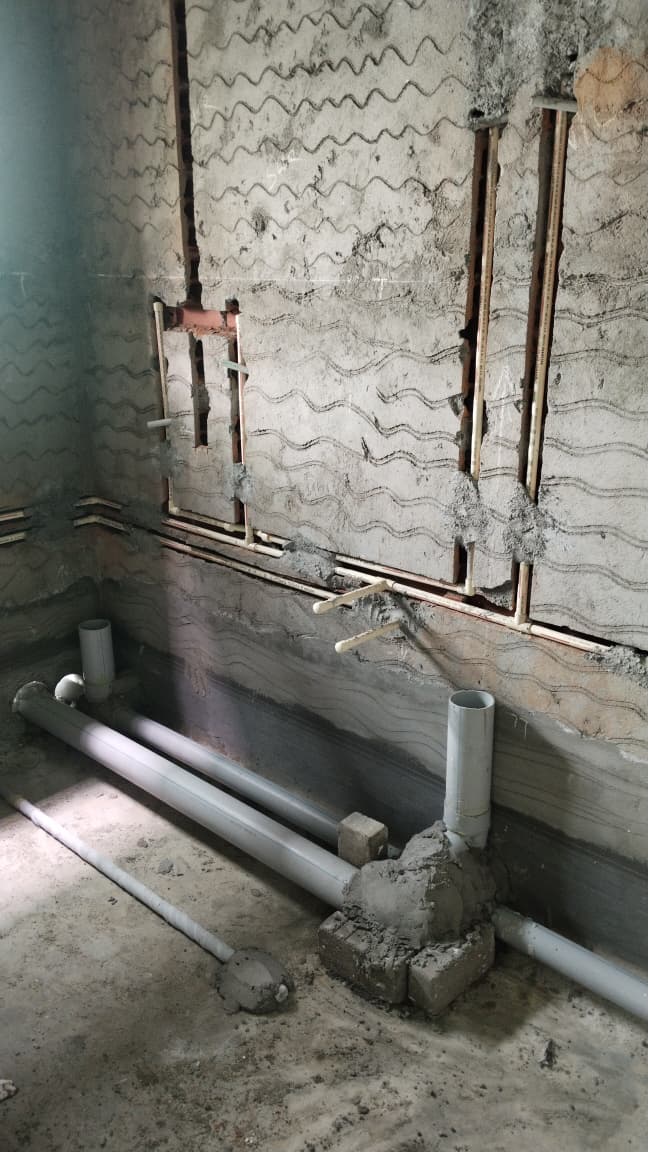

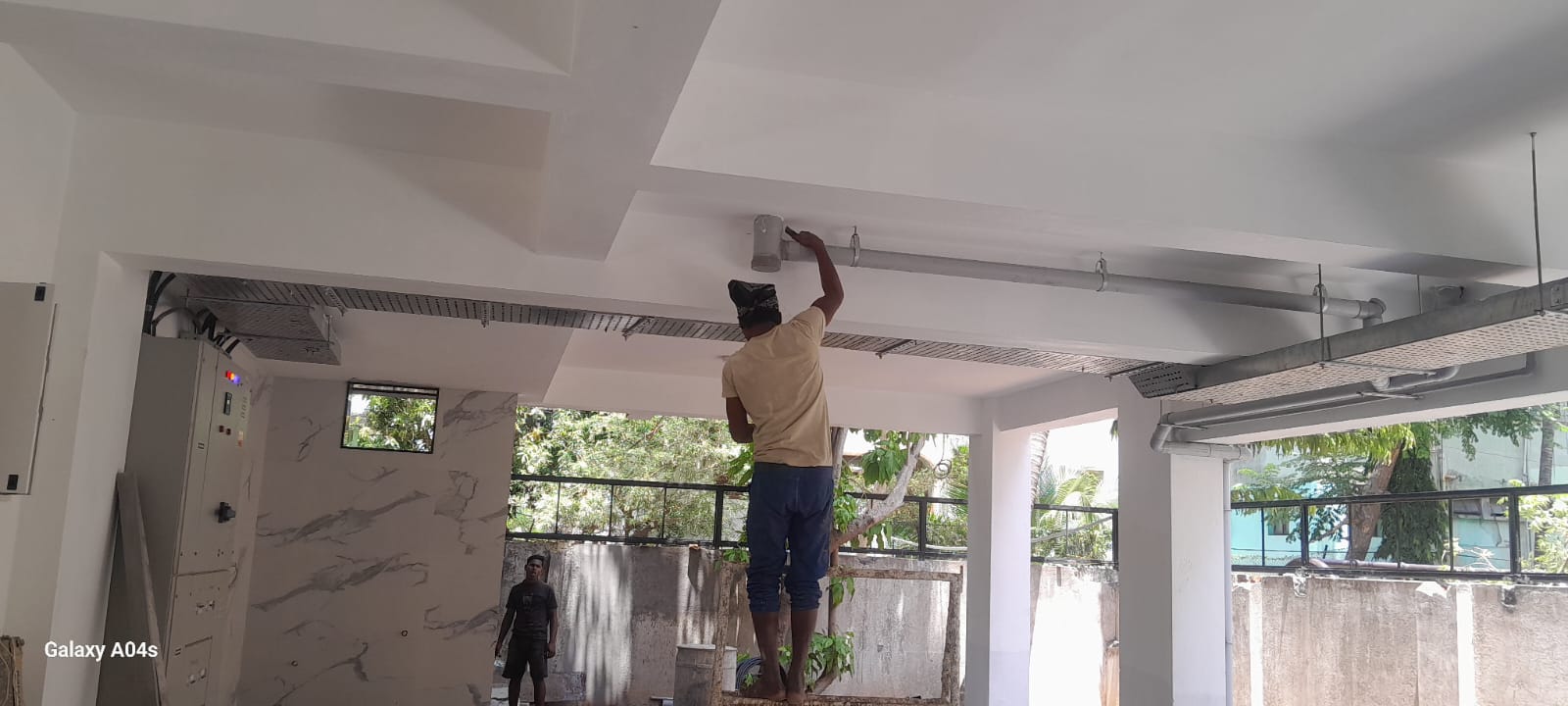

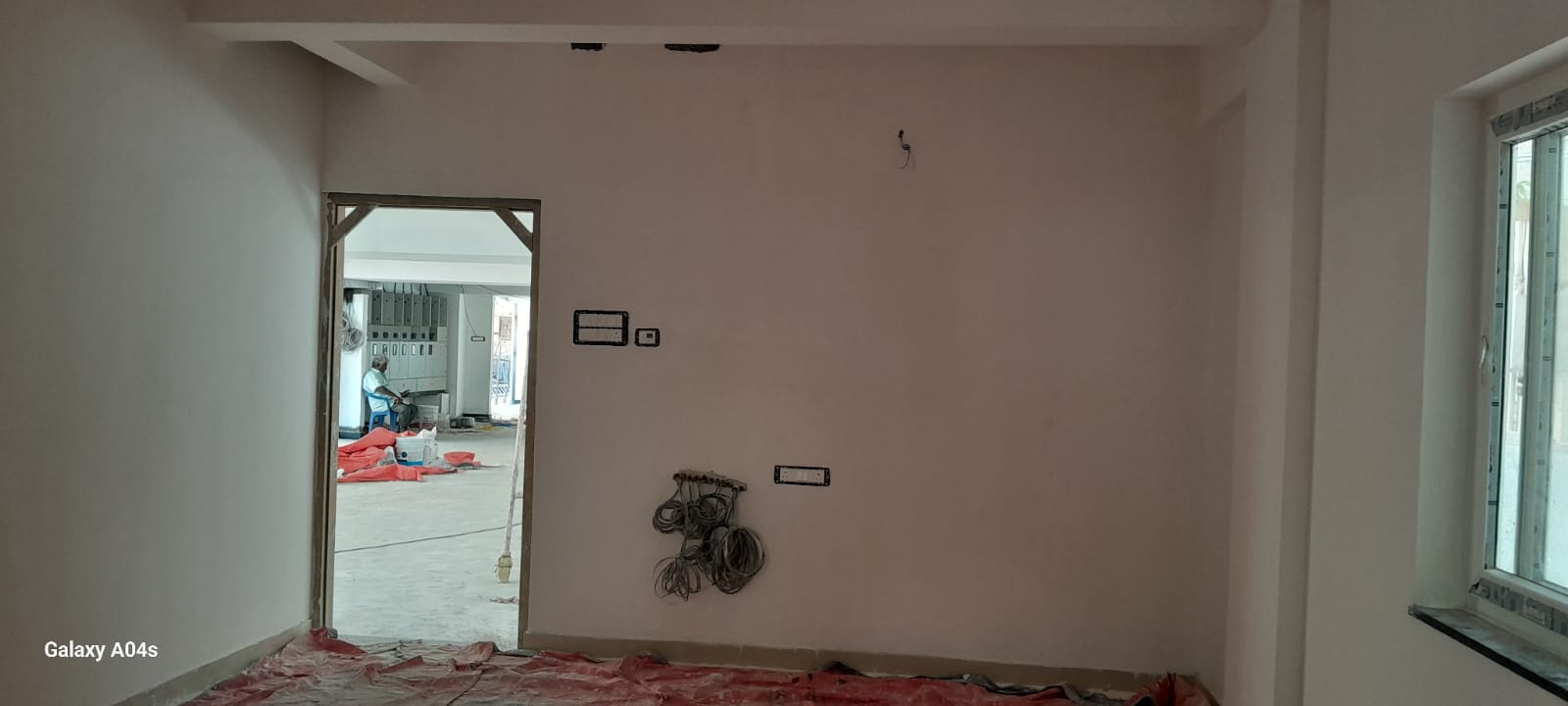

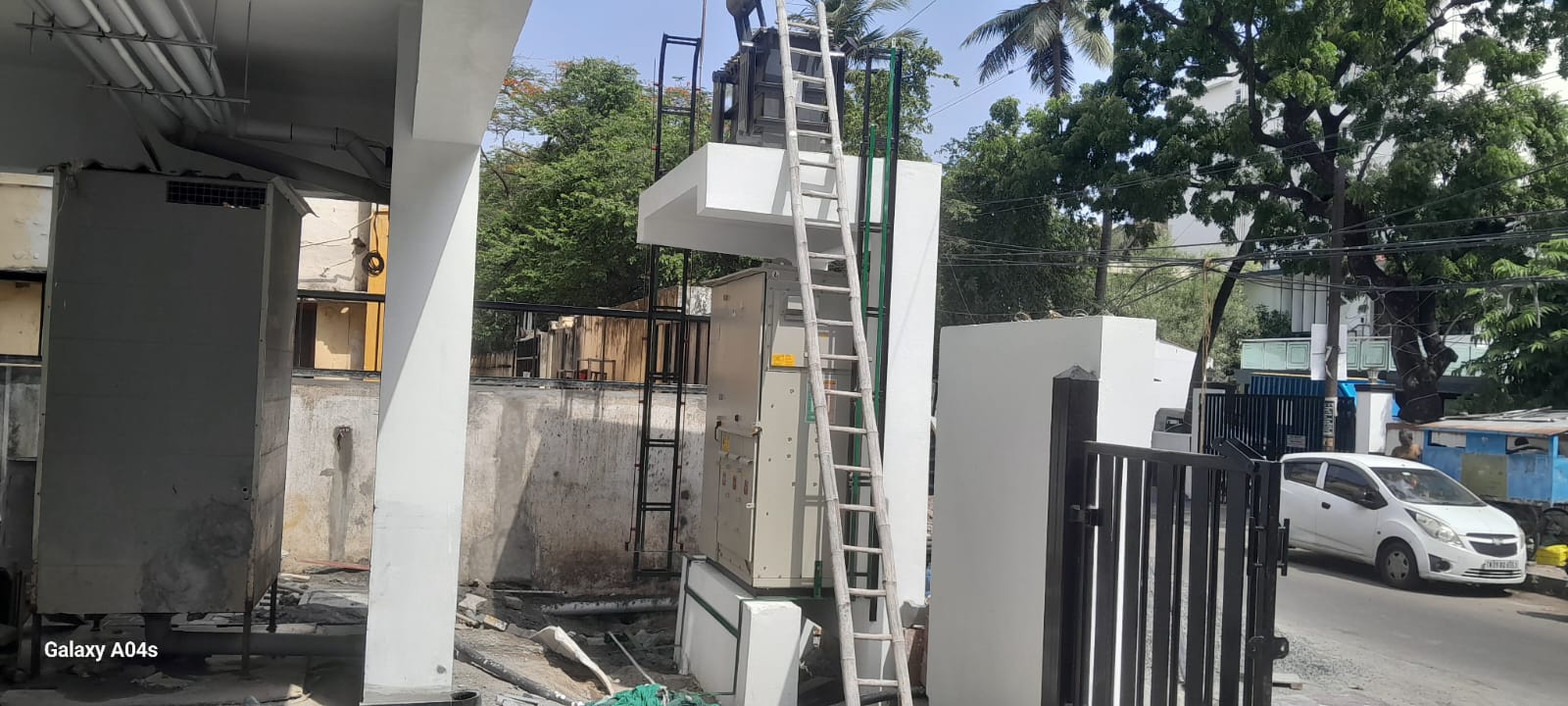

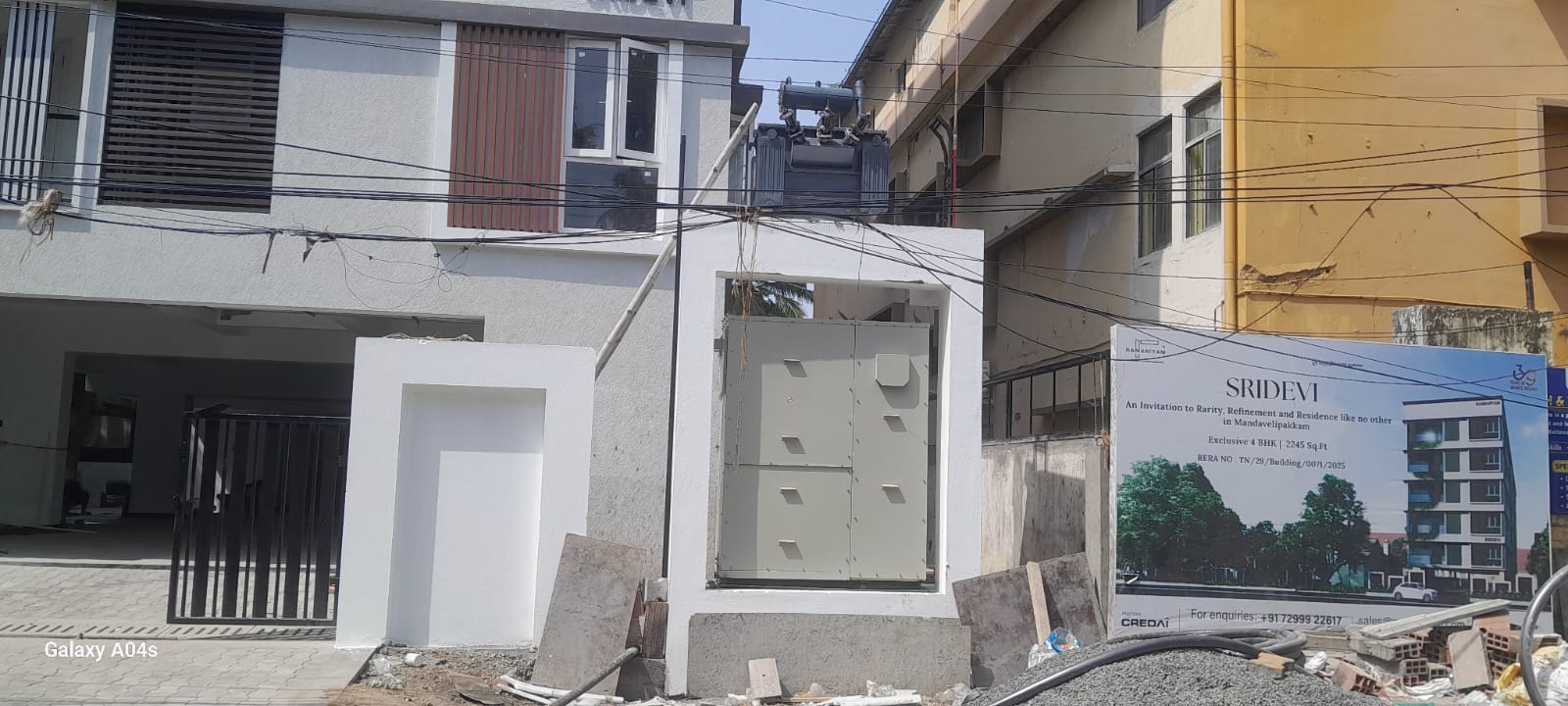

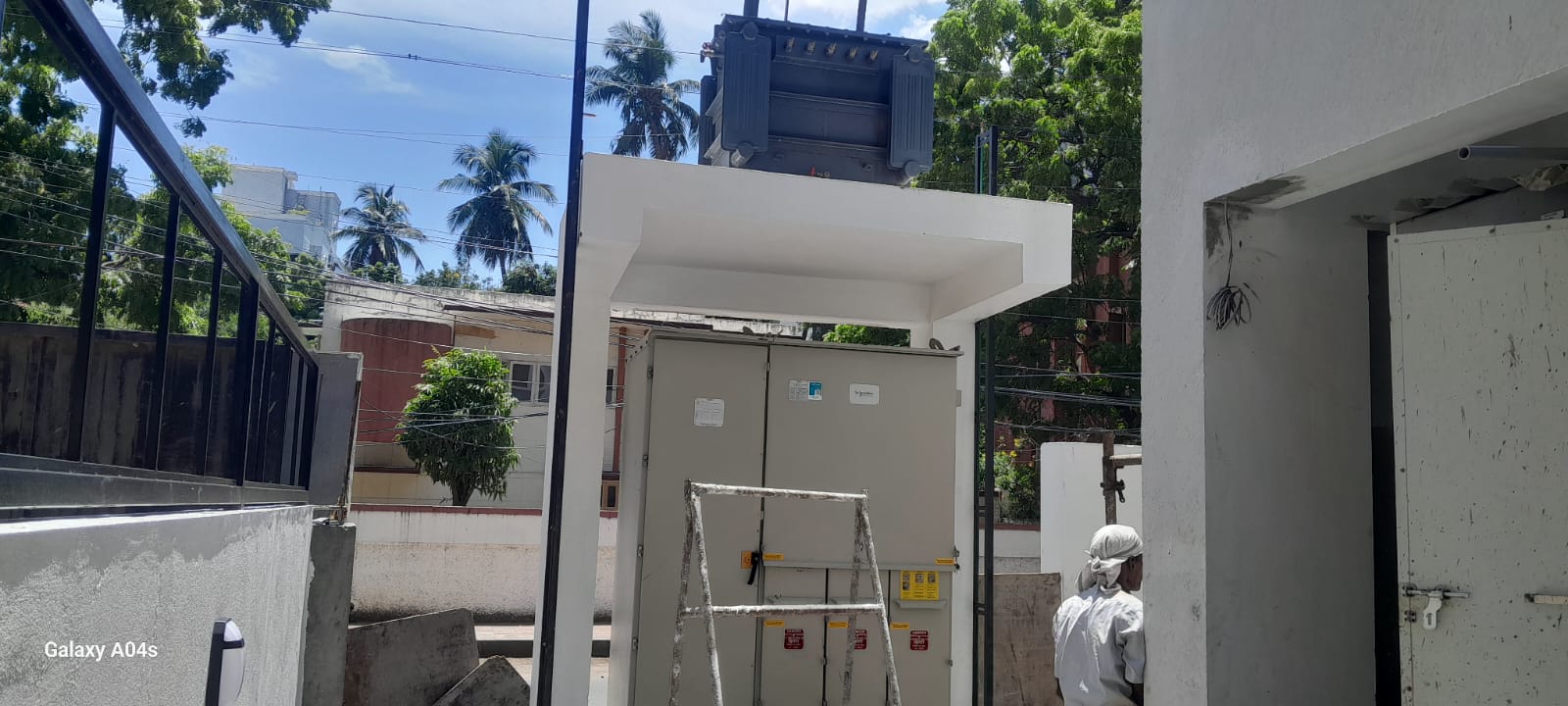

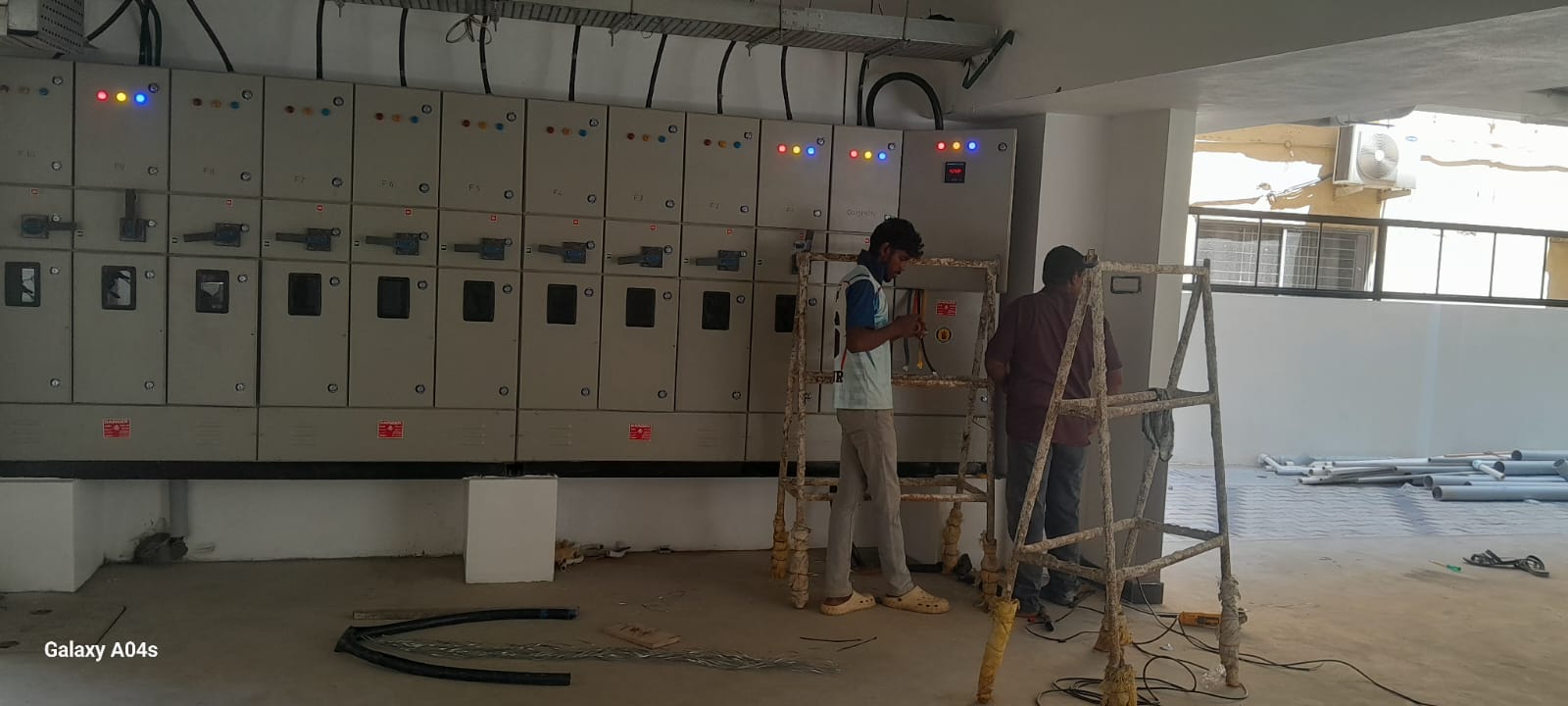

  • EB panel board fixing work is in progress.

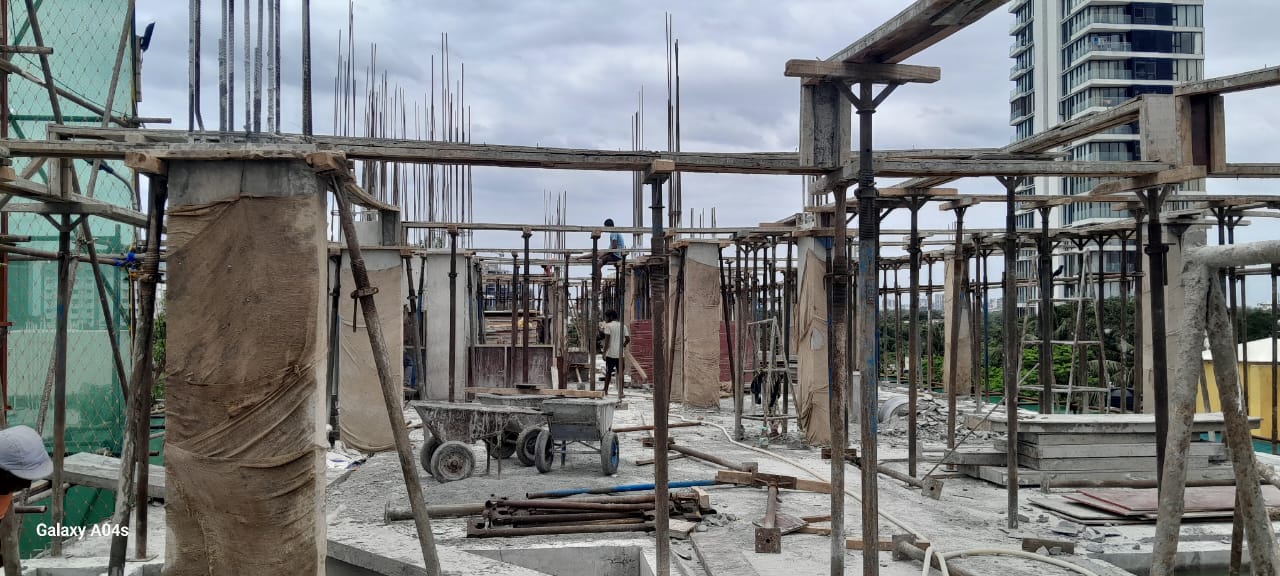

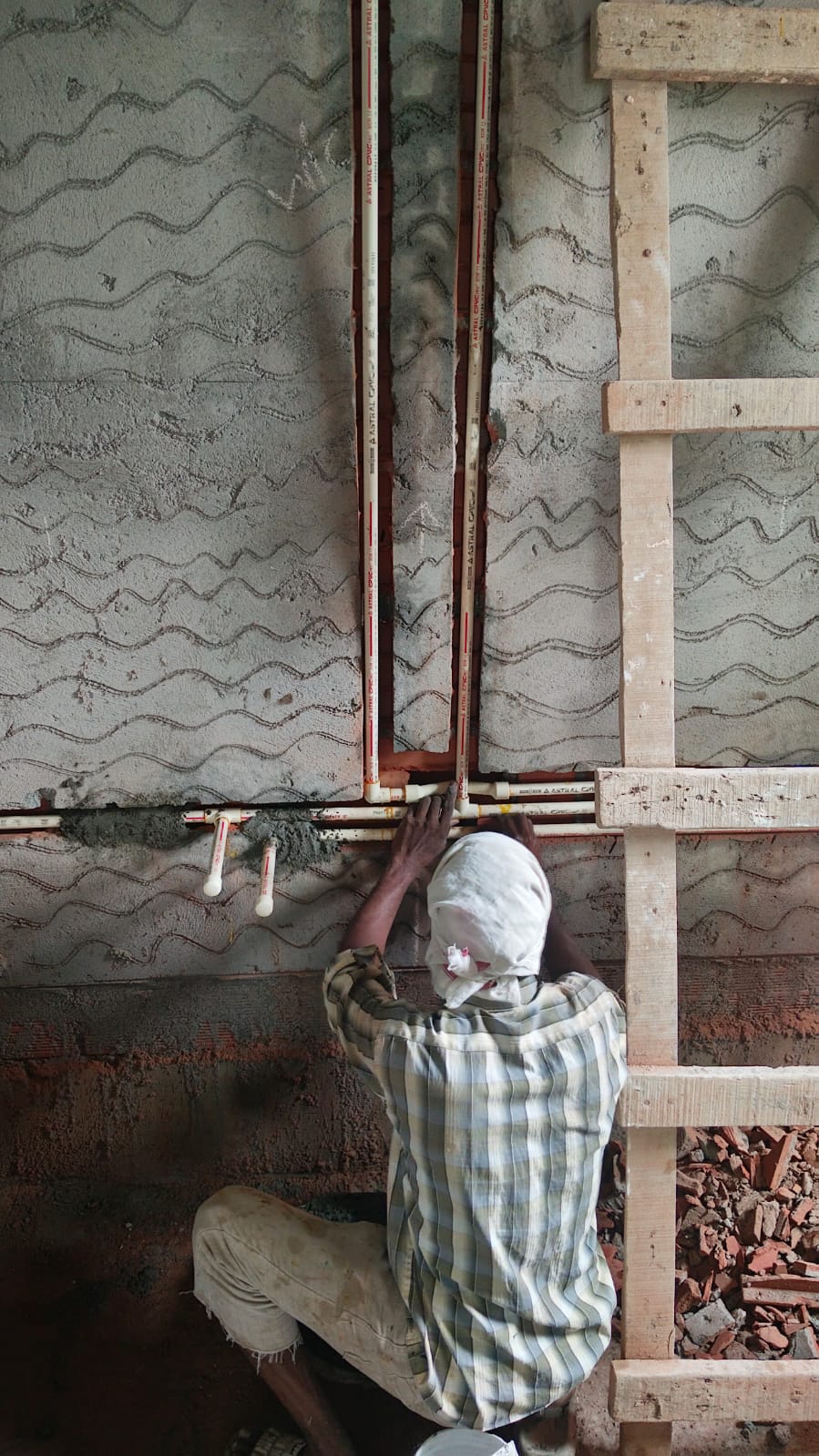

  • RMU work is in progress.

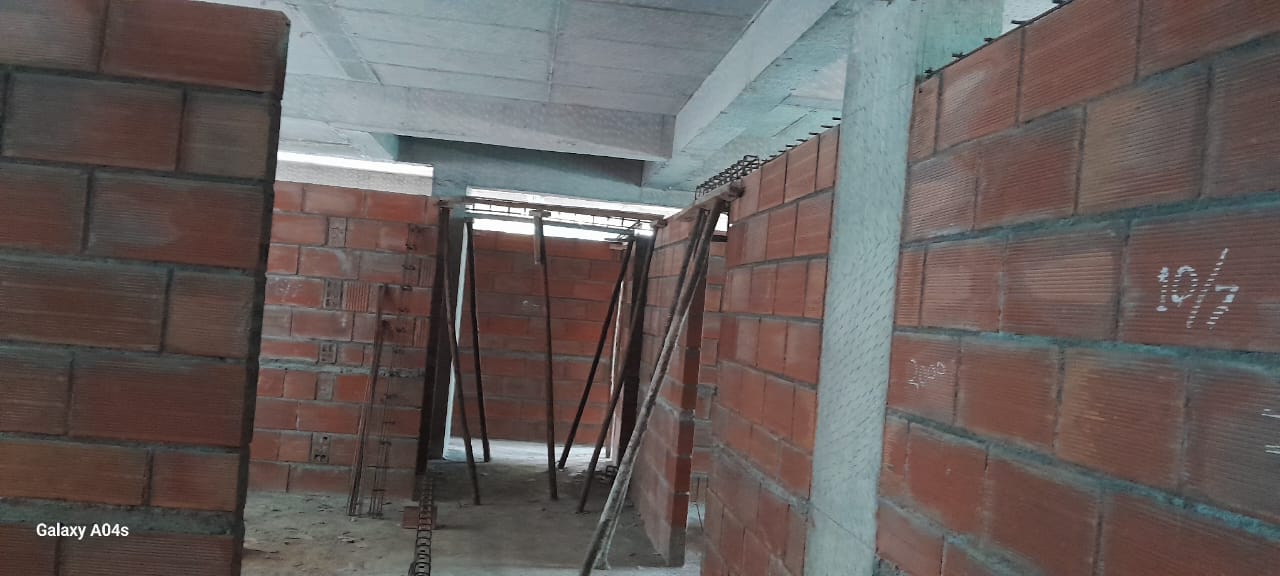

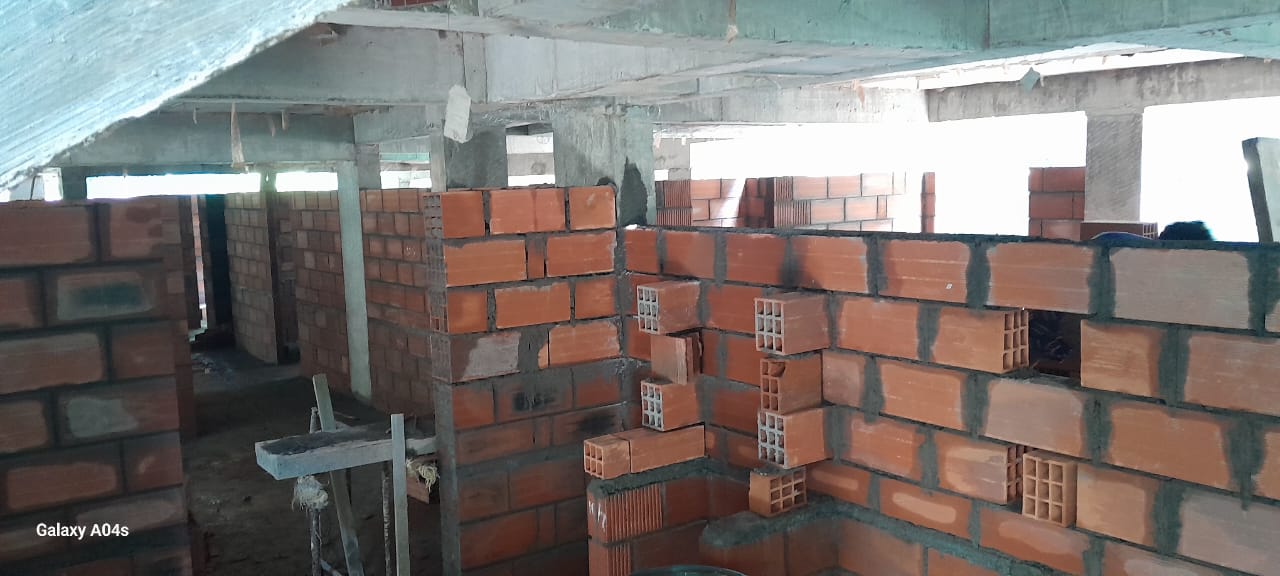

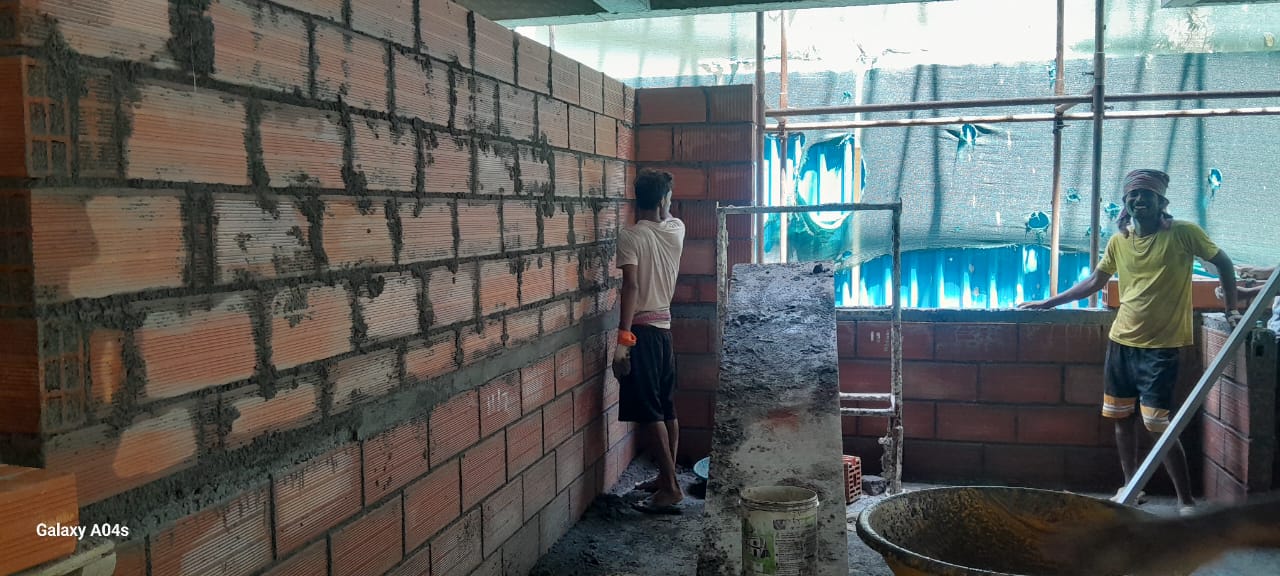

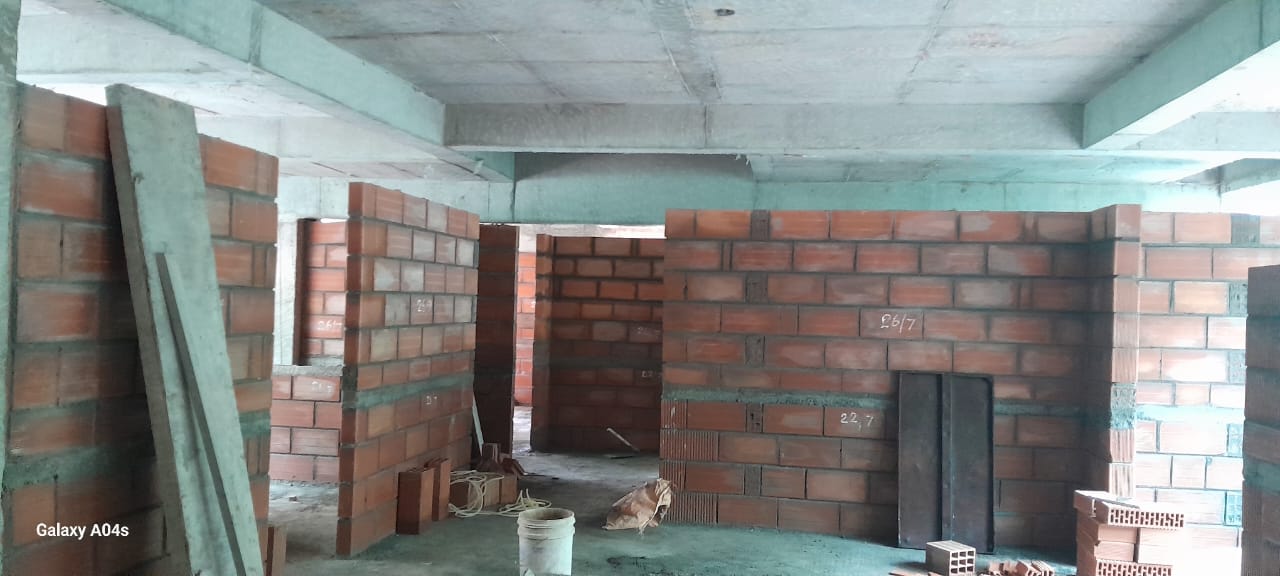

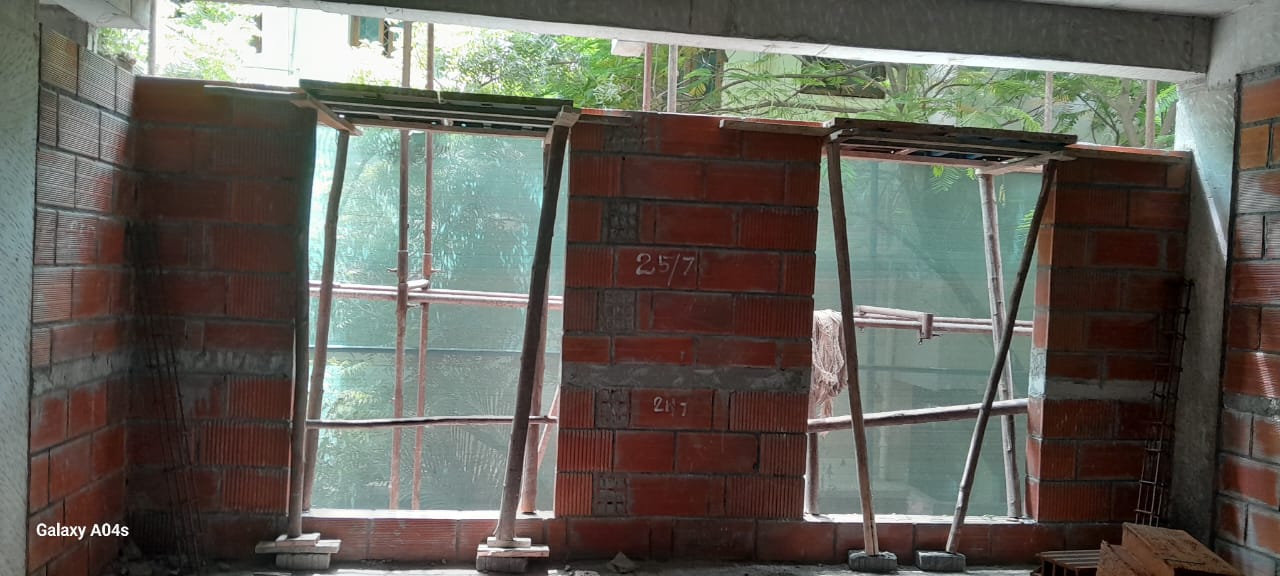

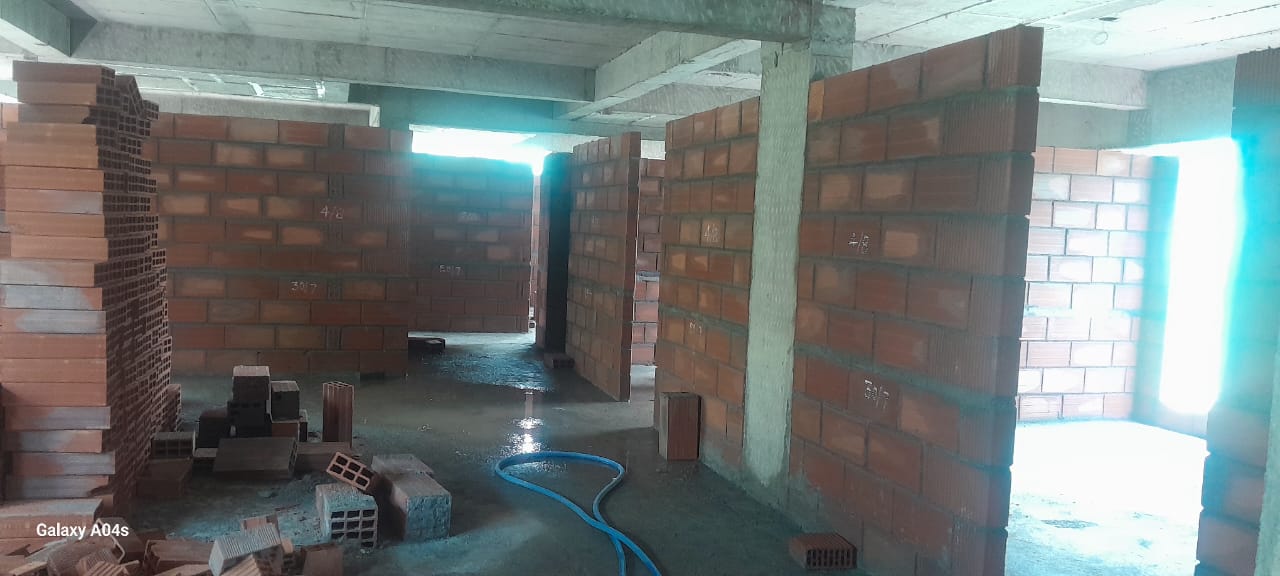

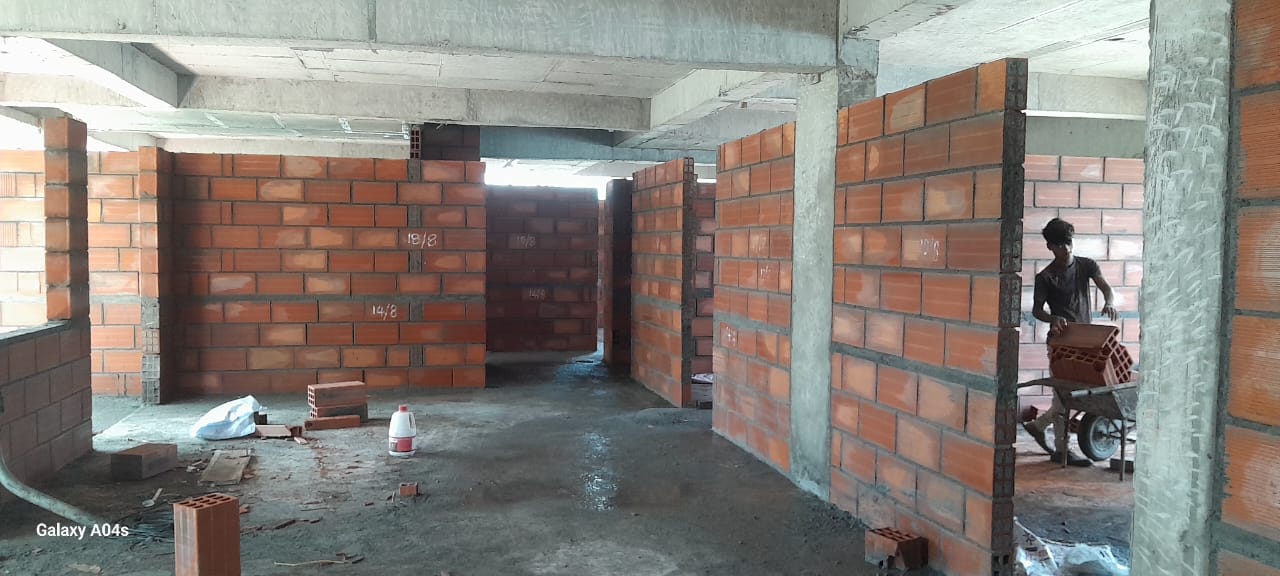

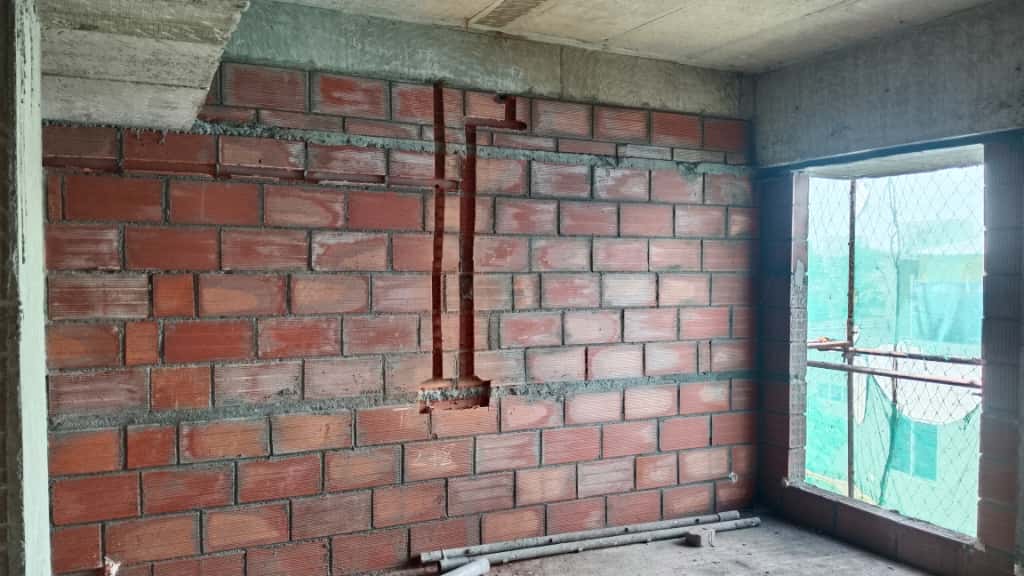

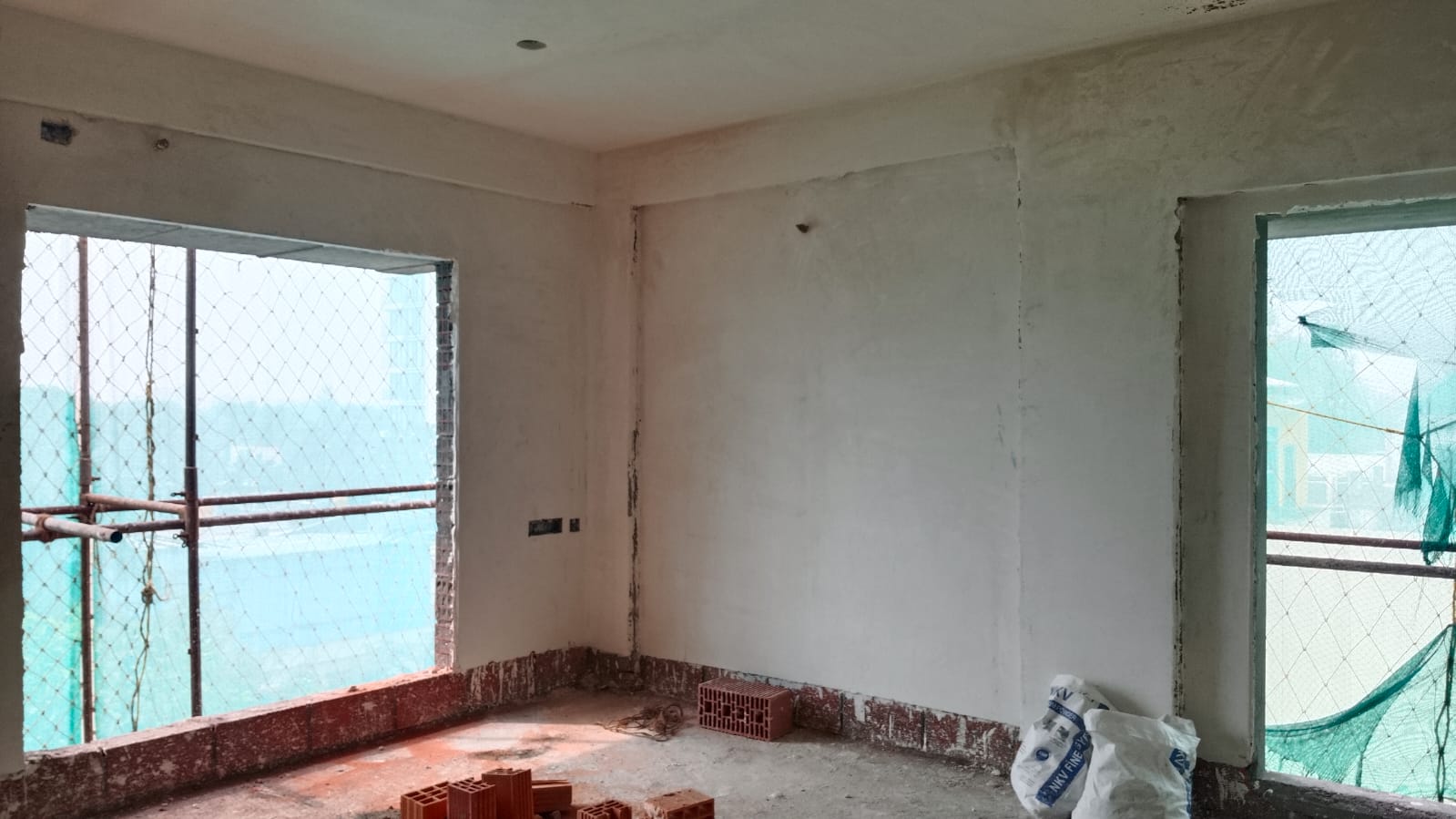

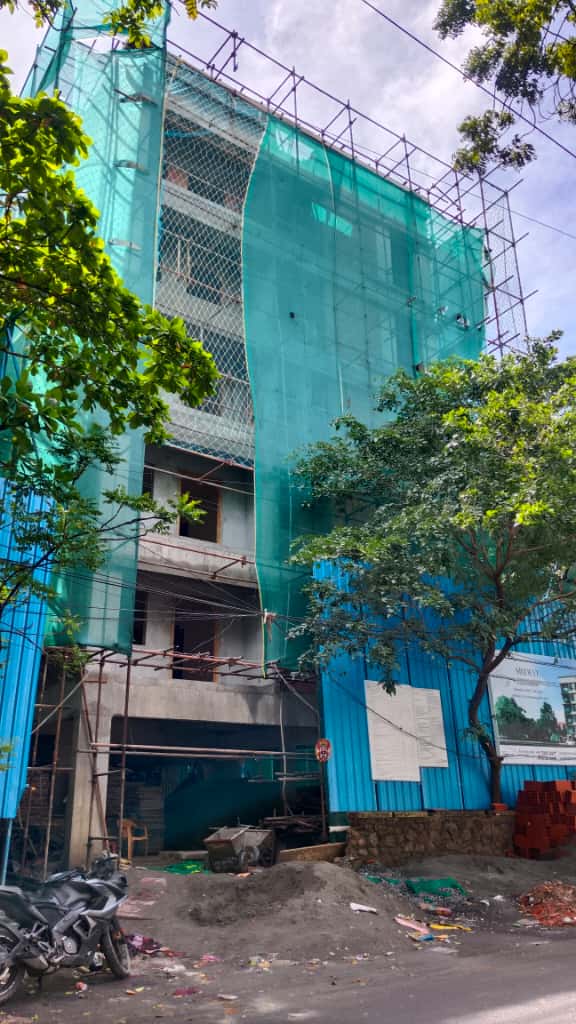

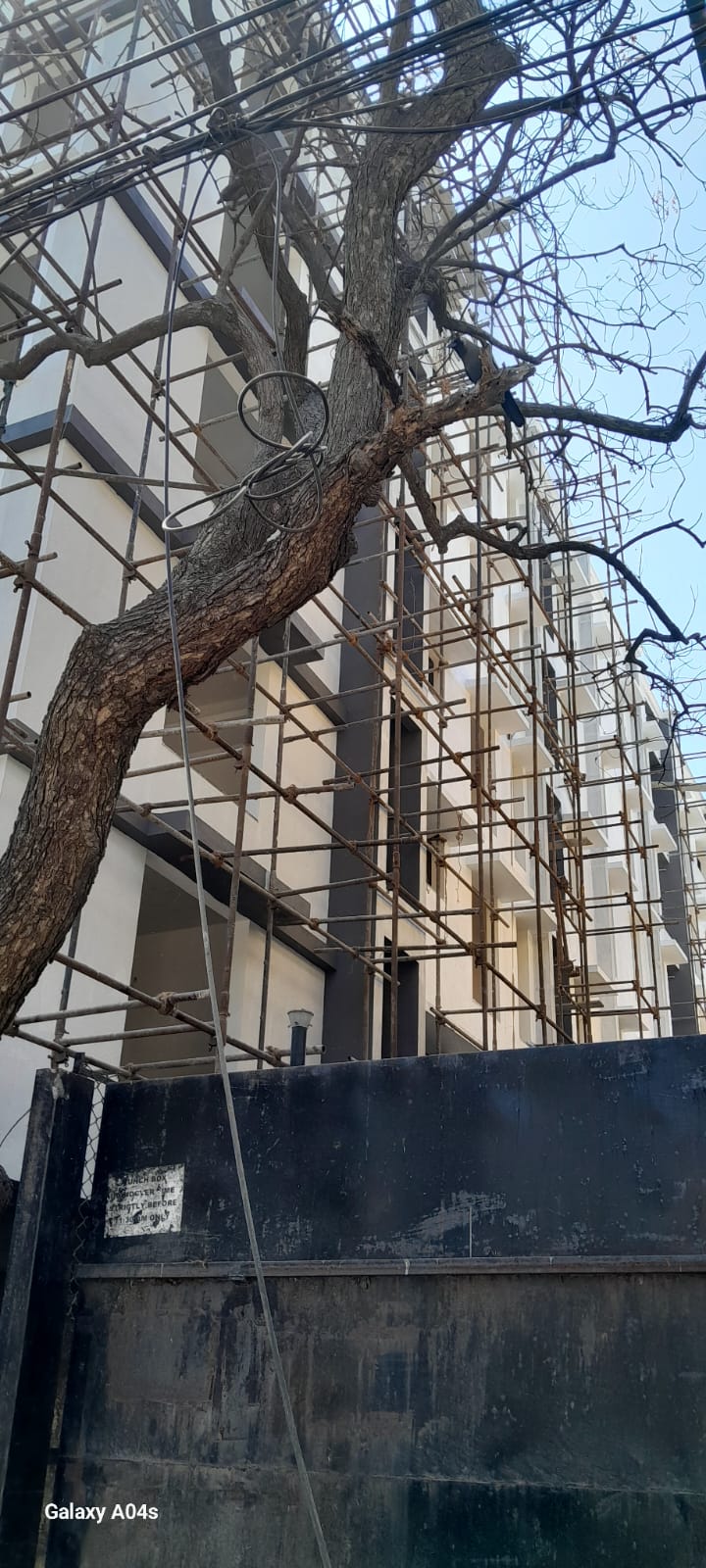

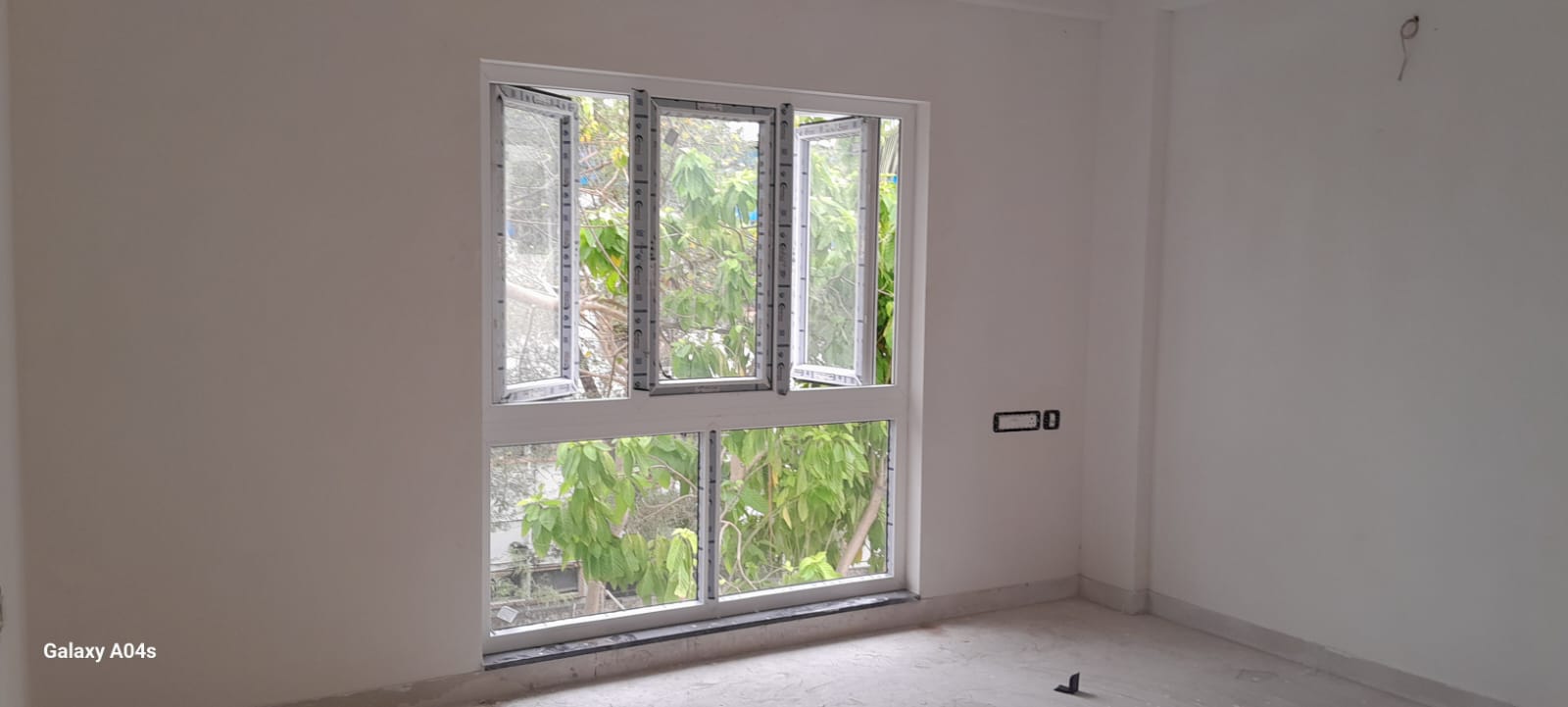

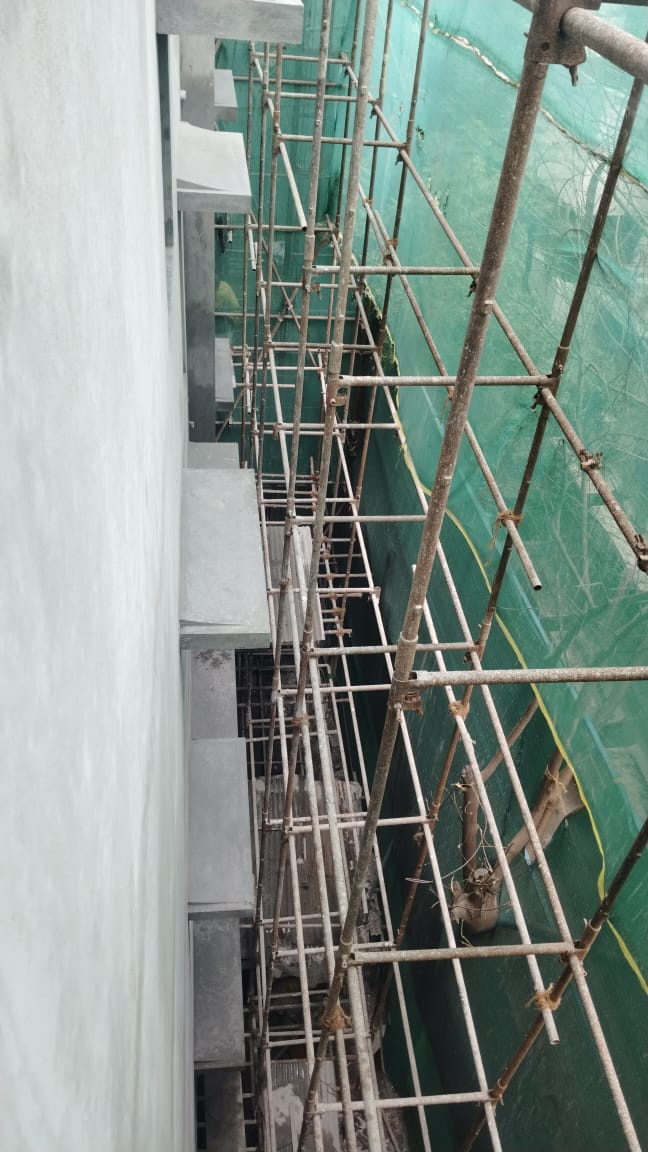

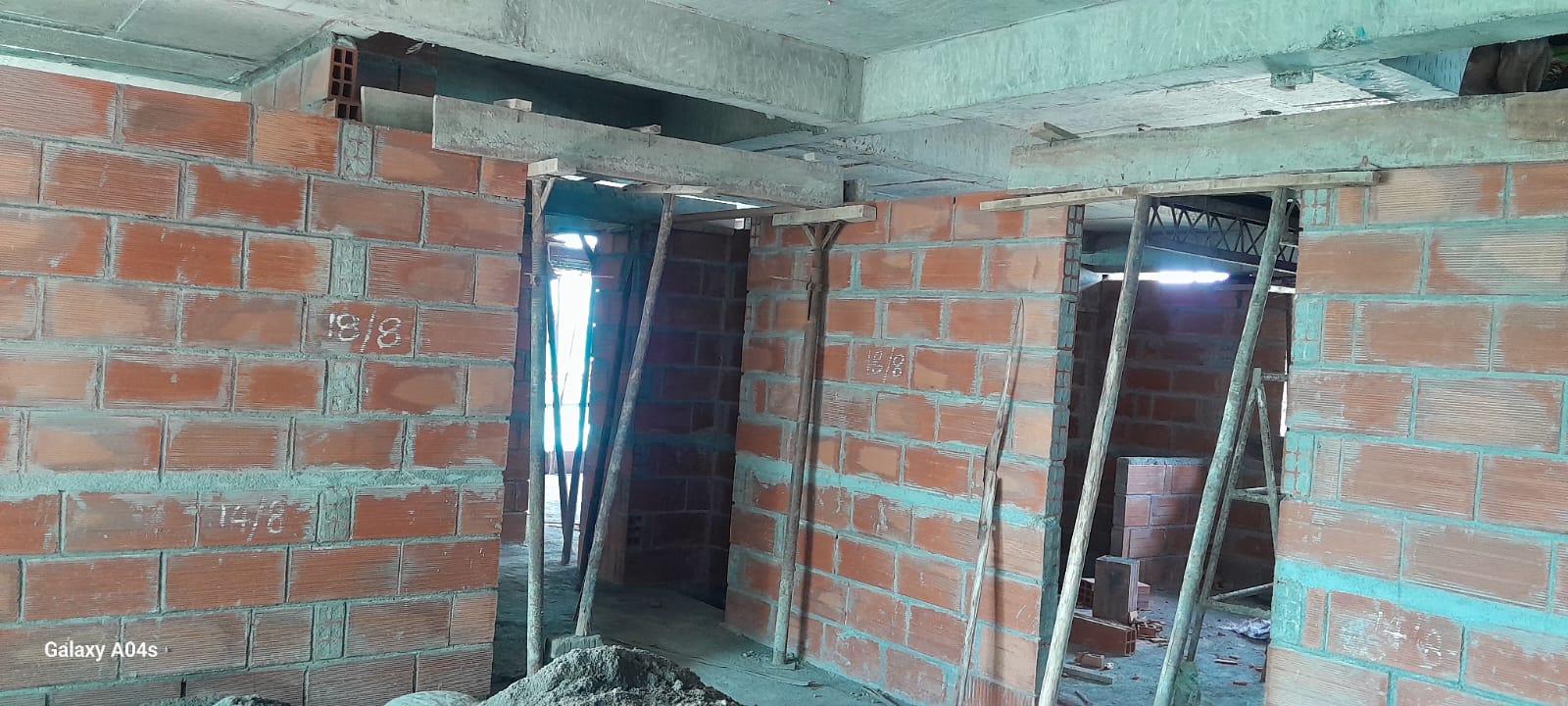

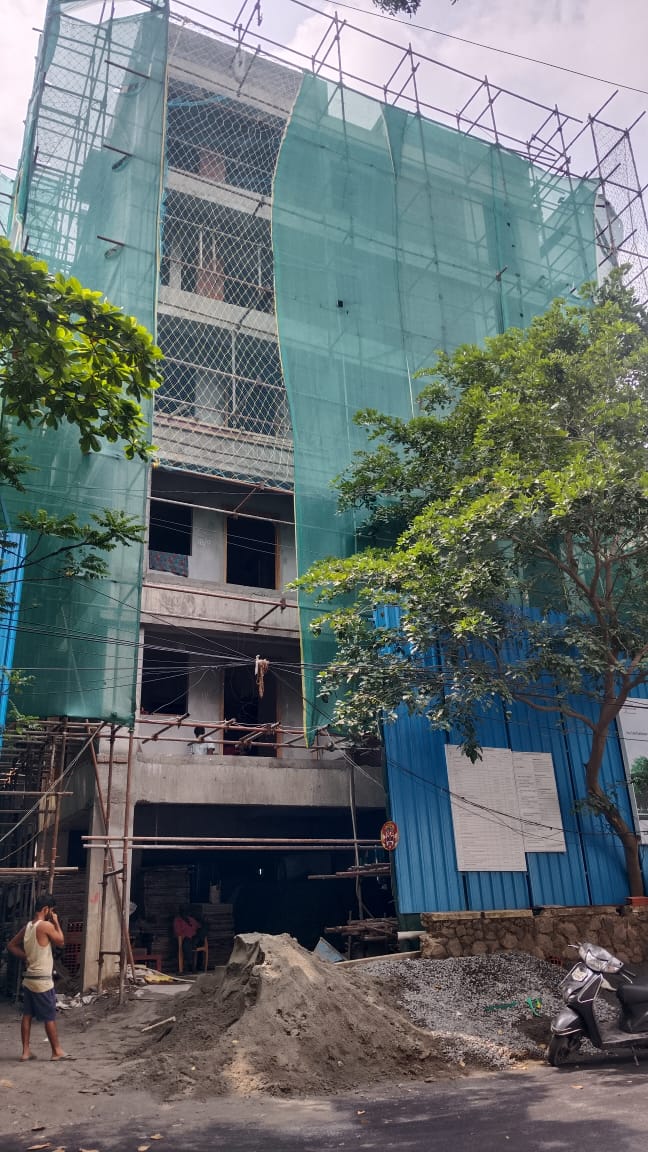

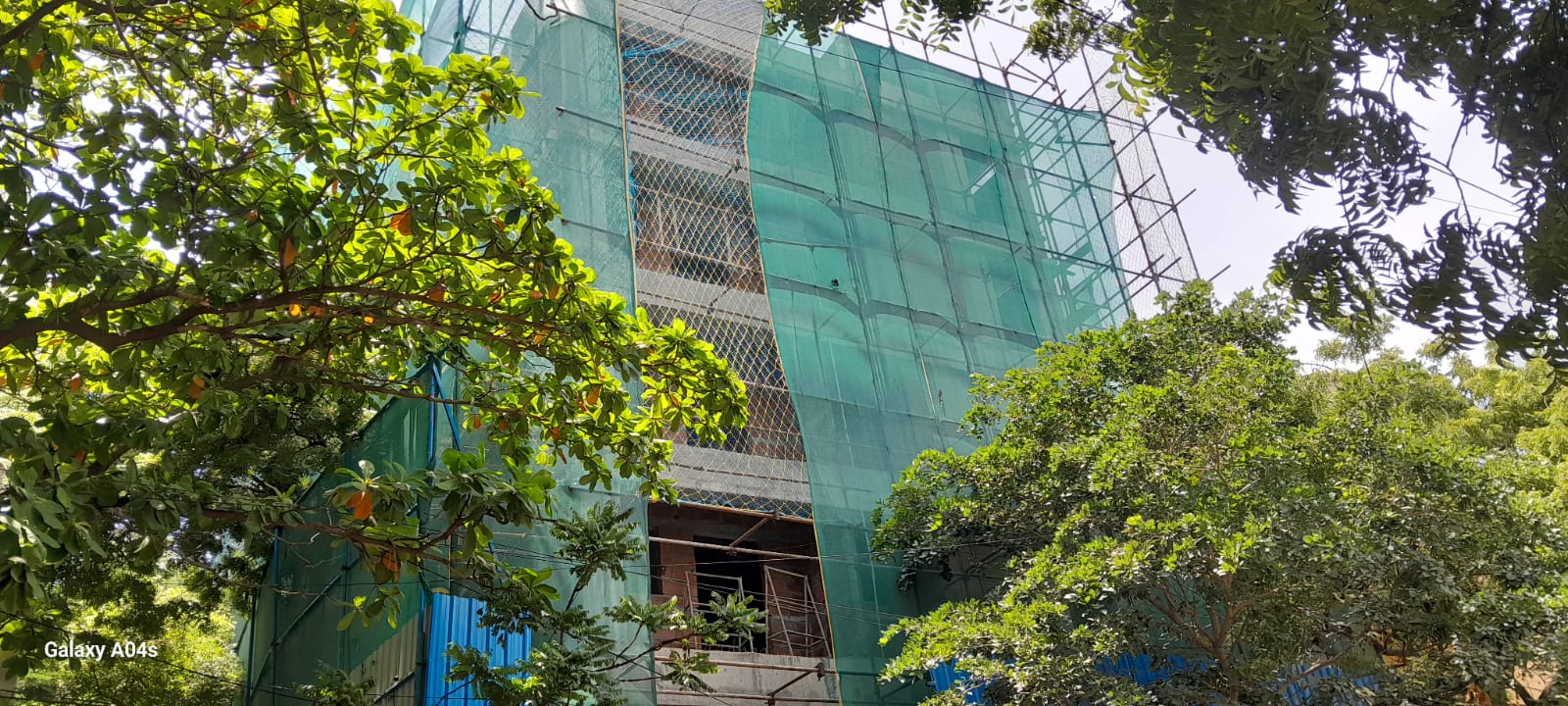

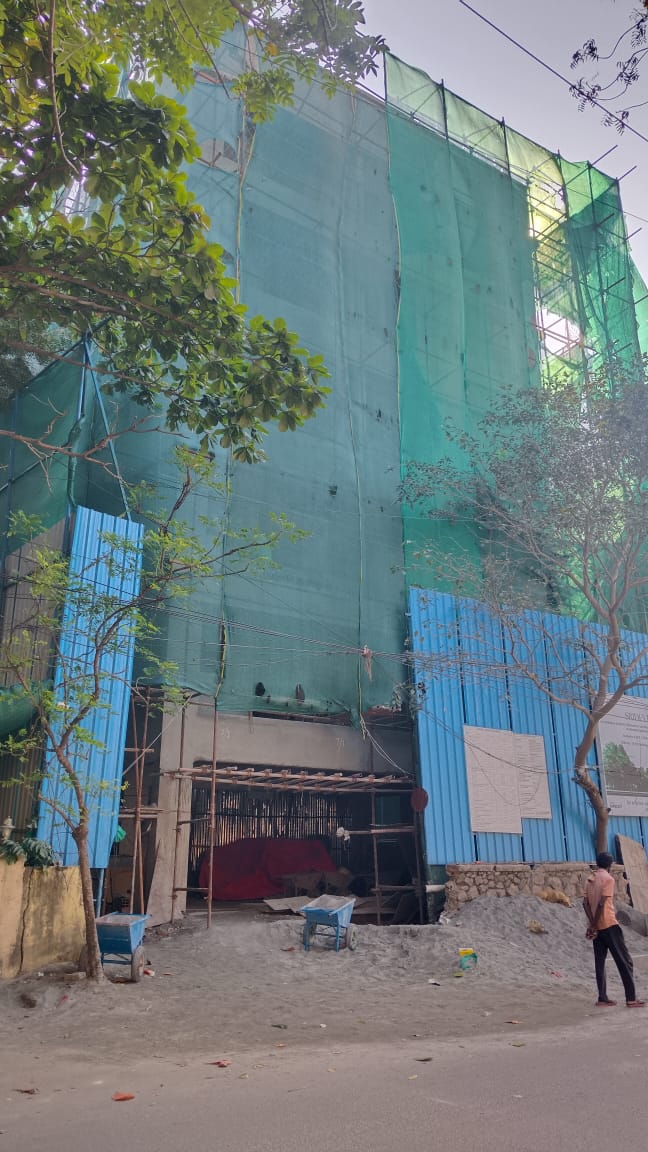

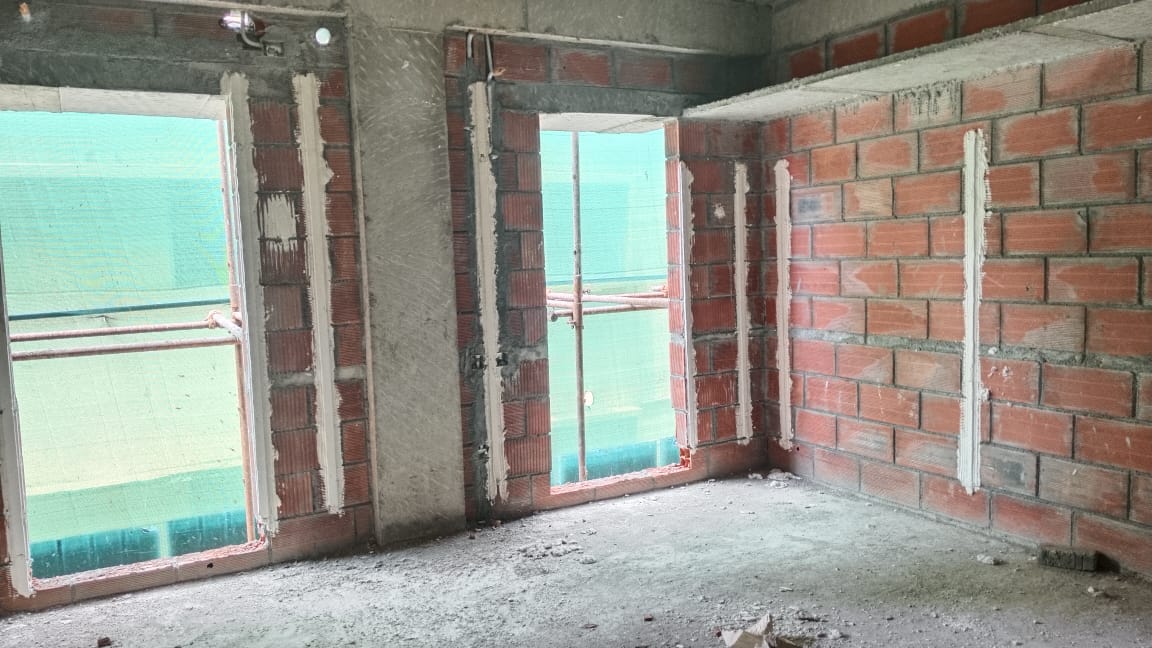

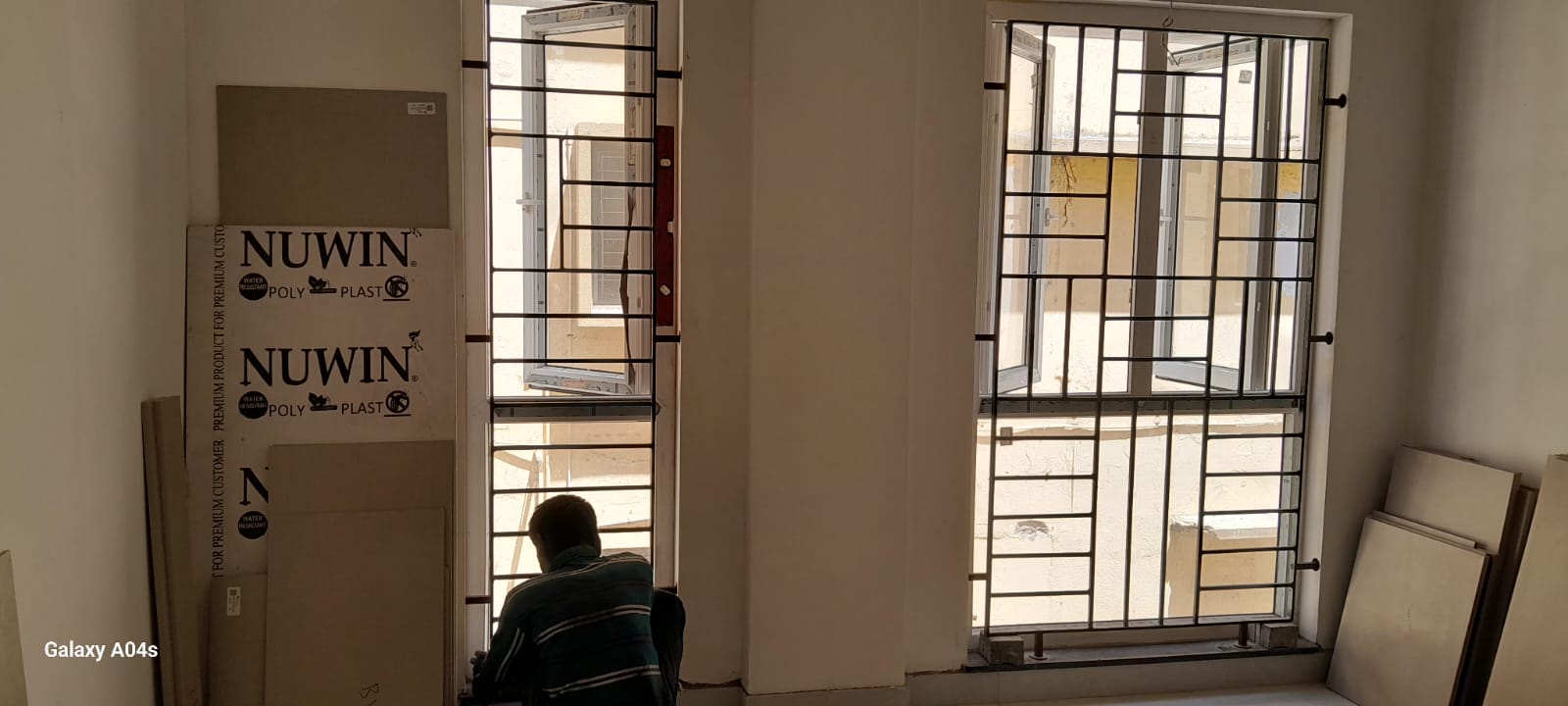

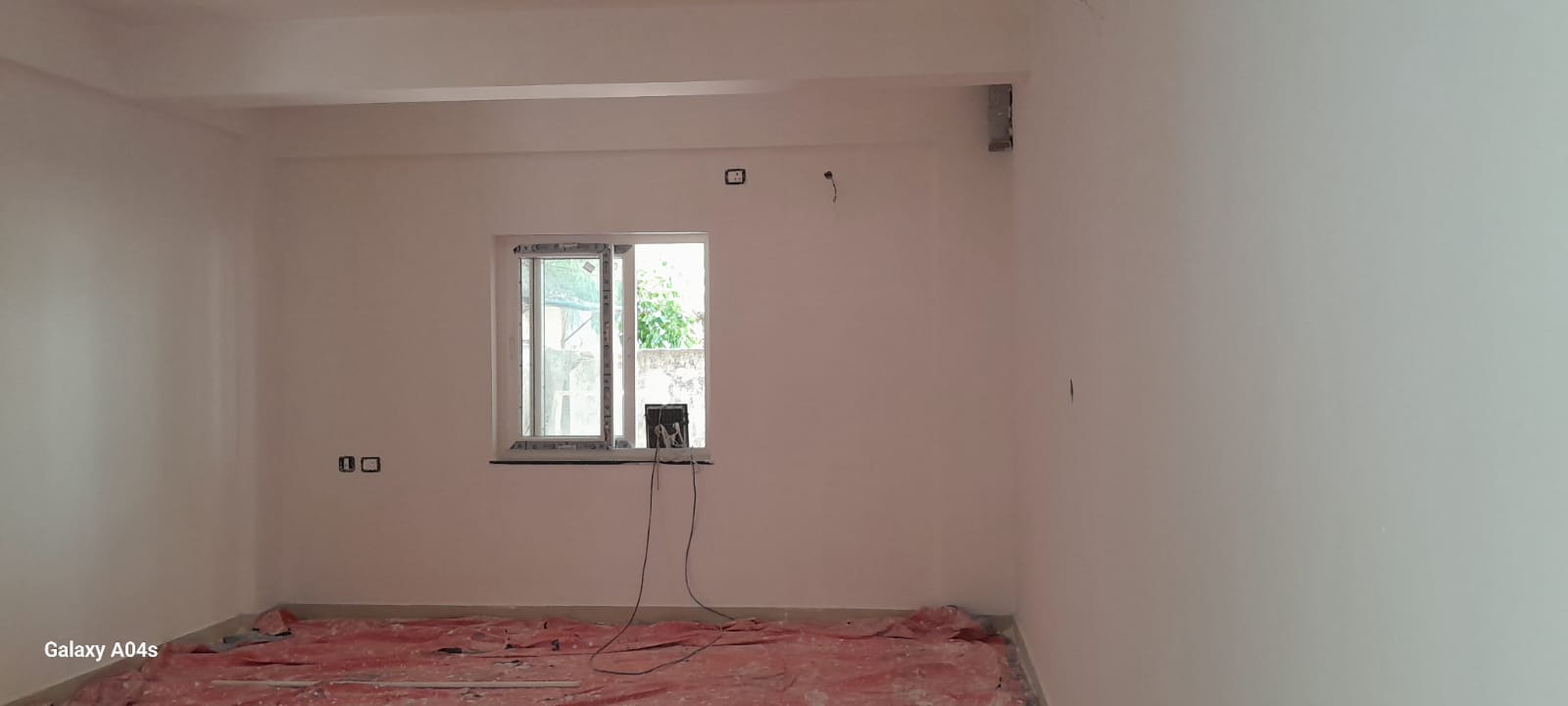

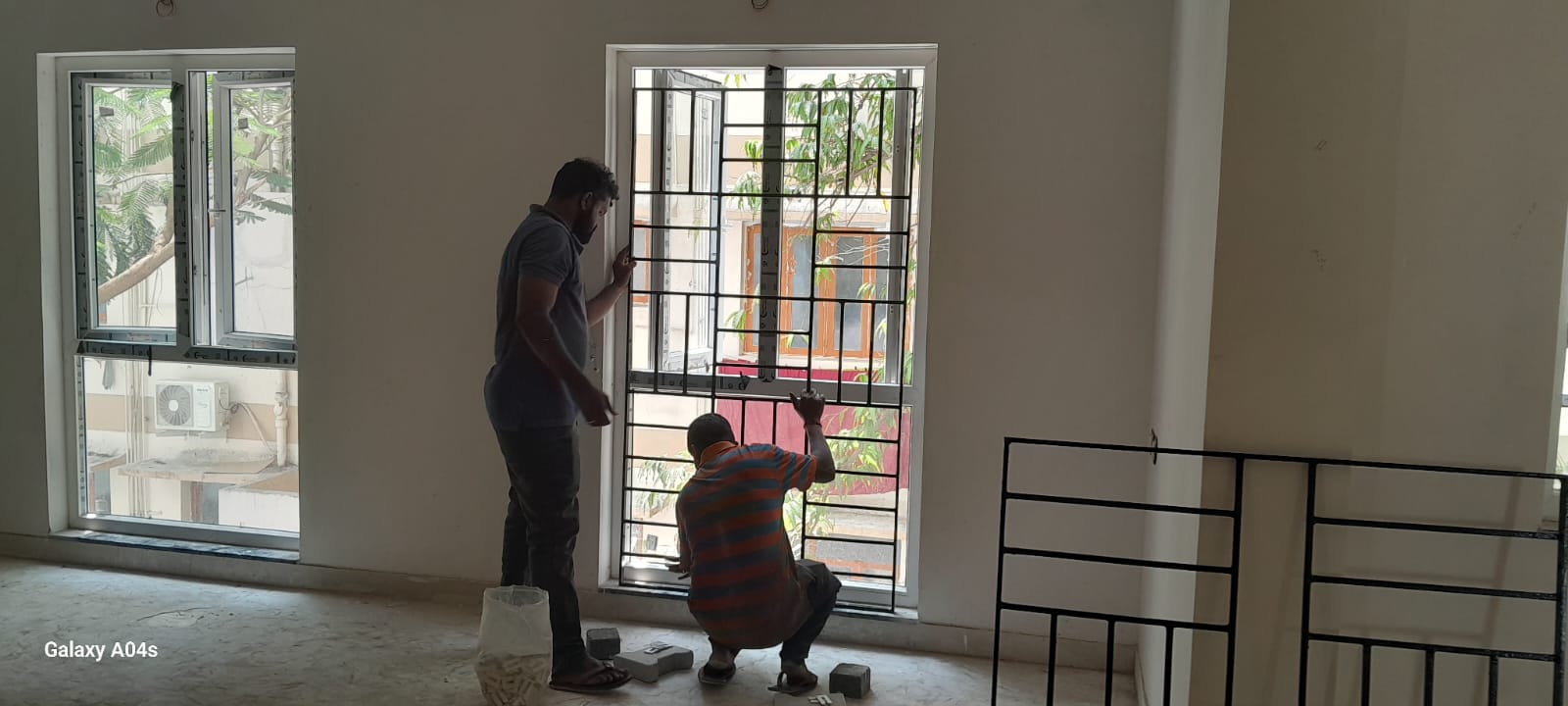

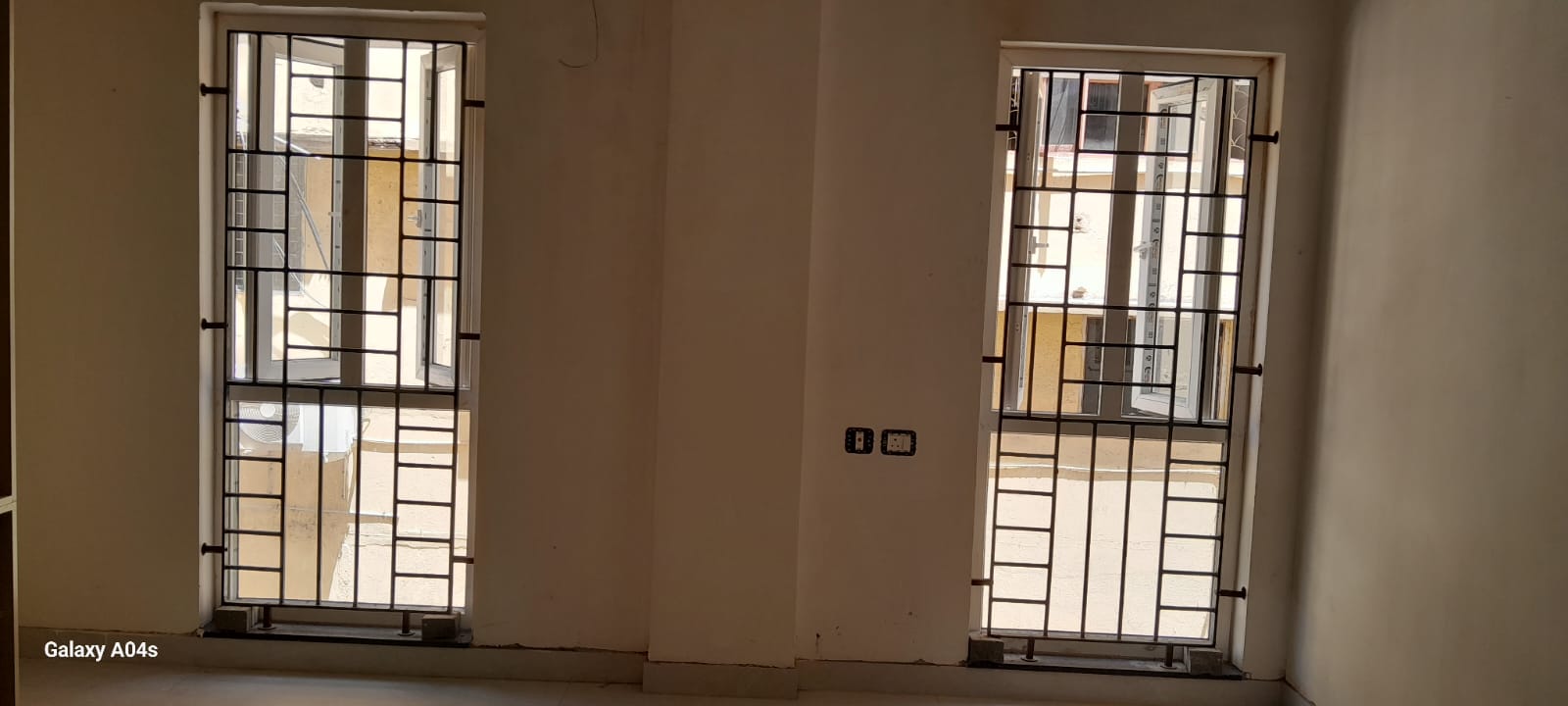

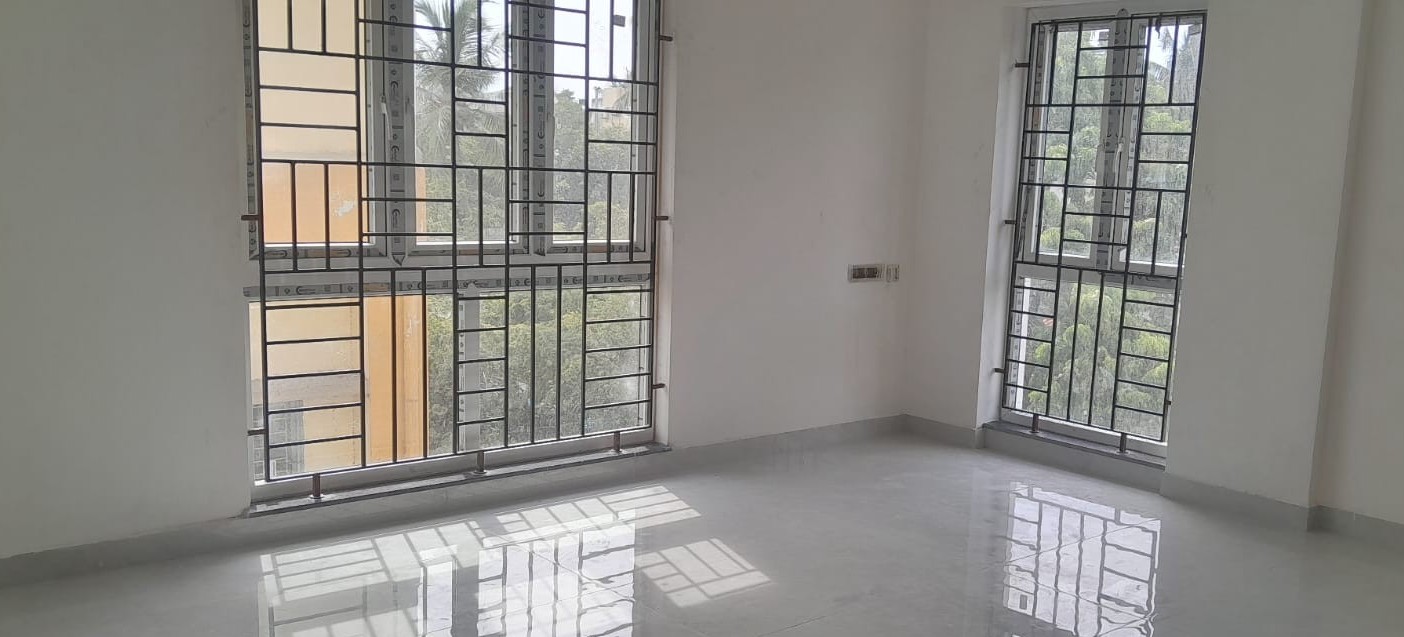

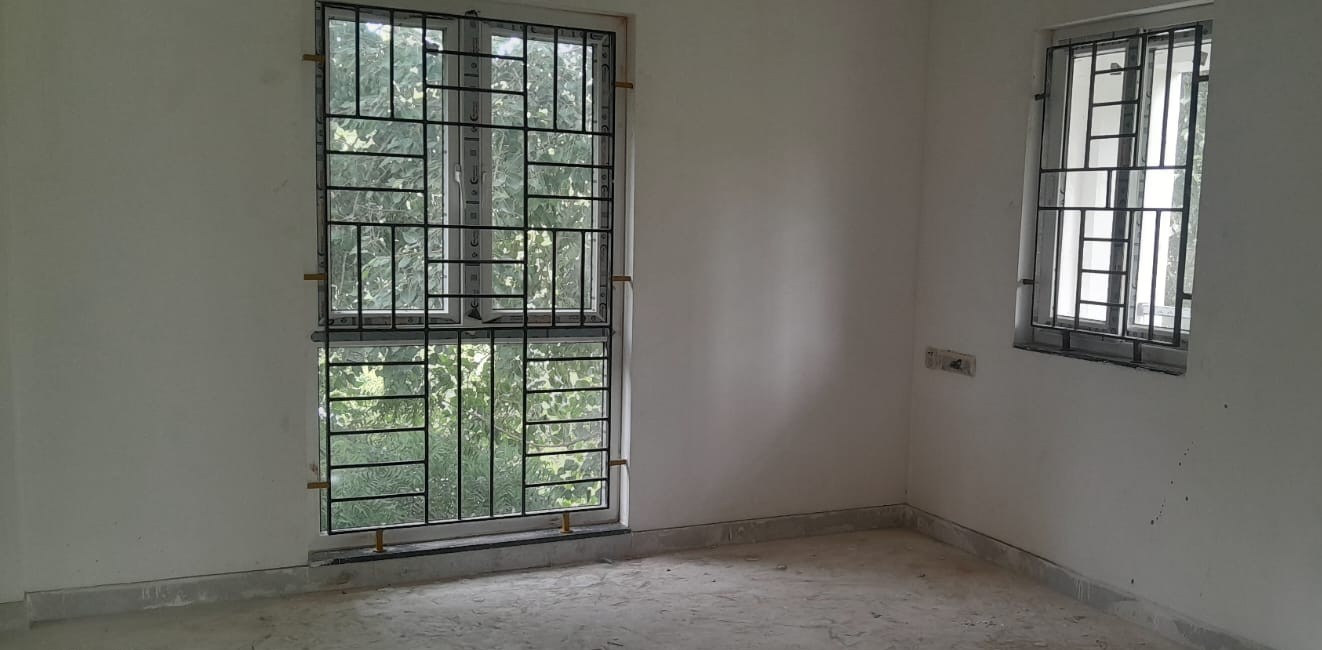

  • All floors windows grill fixing work is in progress.
  • Inner putty work is in progress. (up to 4th floor completed,5th floor 50% completed)
  • 5th Floor inner primer work is in progress. (Up to 4th floor completed)
  • Wood work is in progress. (flat 2,7 & 8 progress)

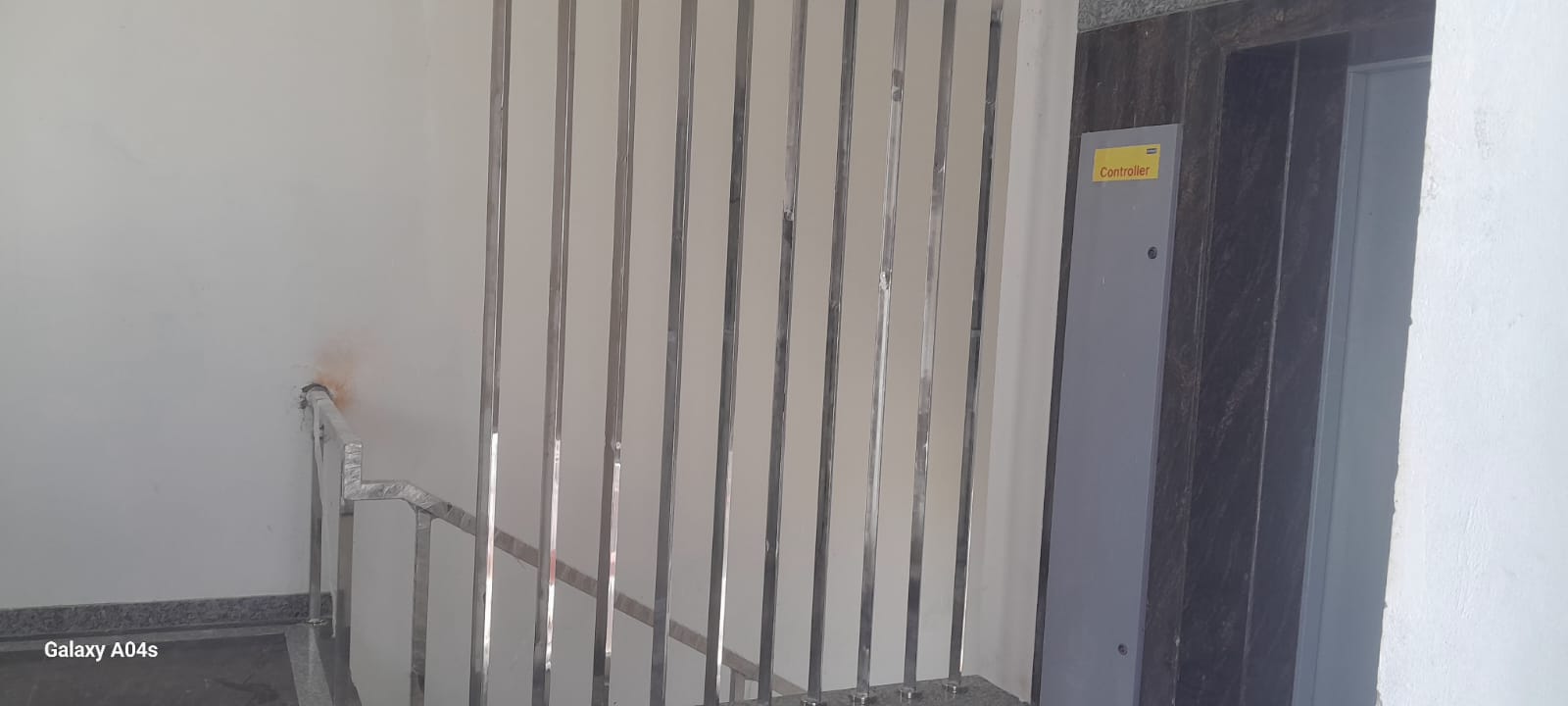

  • EB panel board fixing work is completed.
  • RMU work is completed.

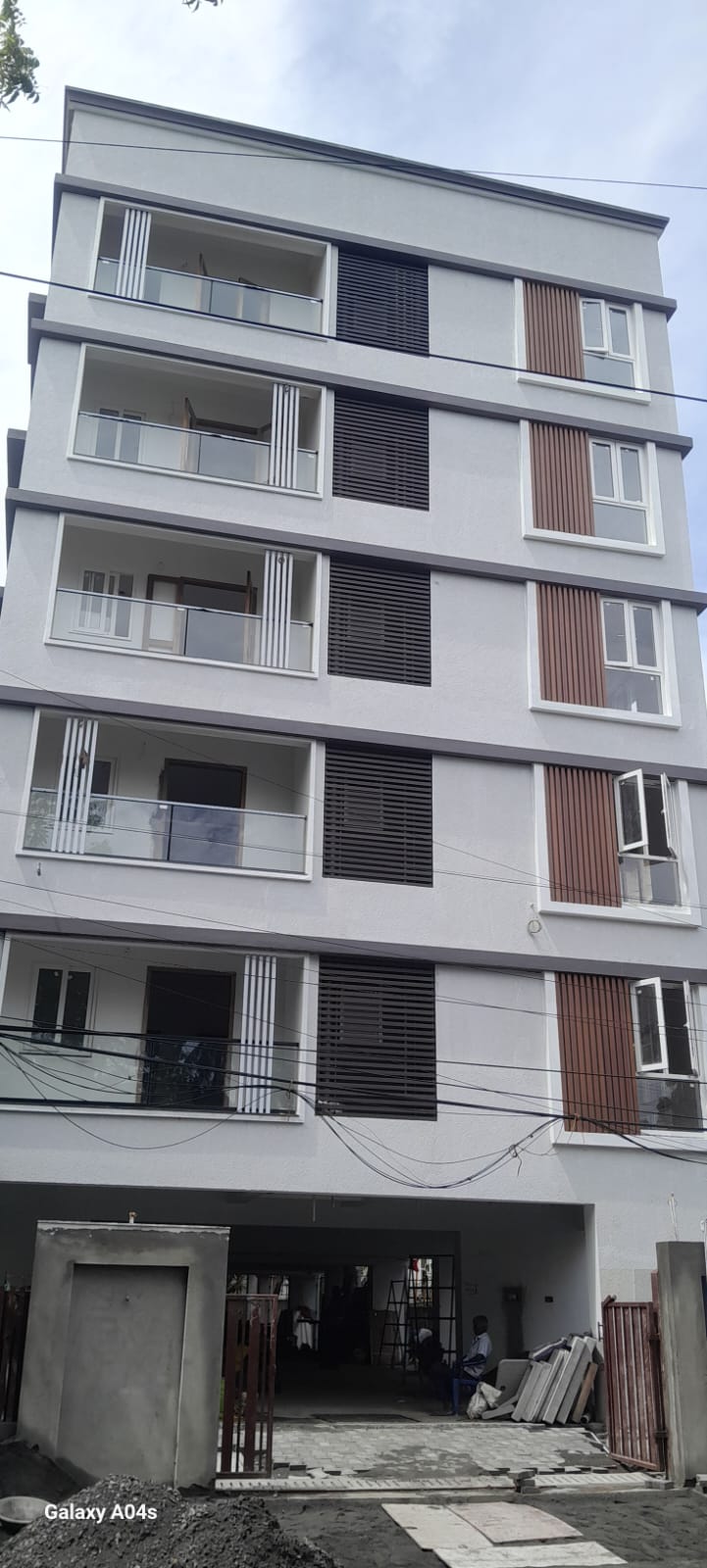

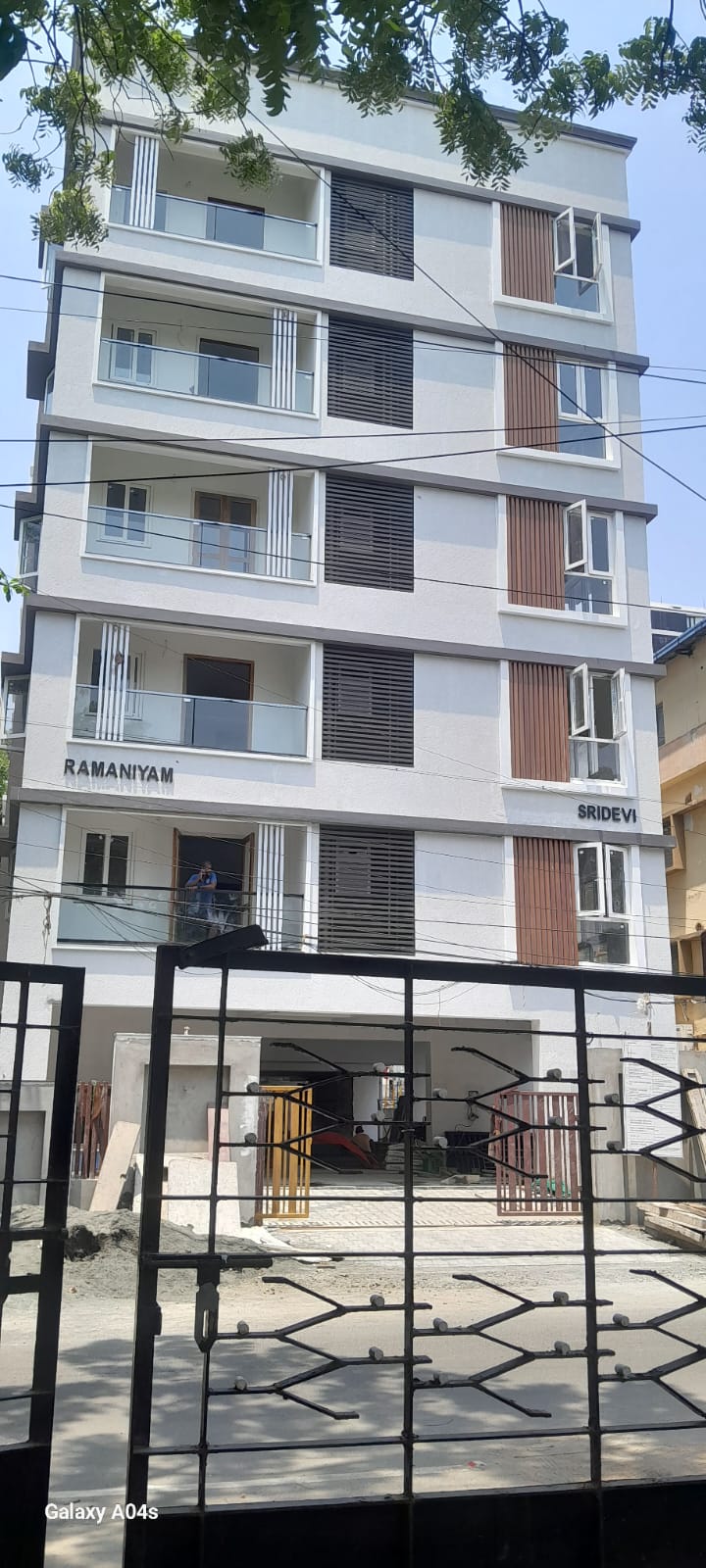

  • CC obtained.
