Sri Vaikuntam

Nanganallur

Enquire Now

Amenities

Generator Backup

CCTV

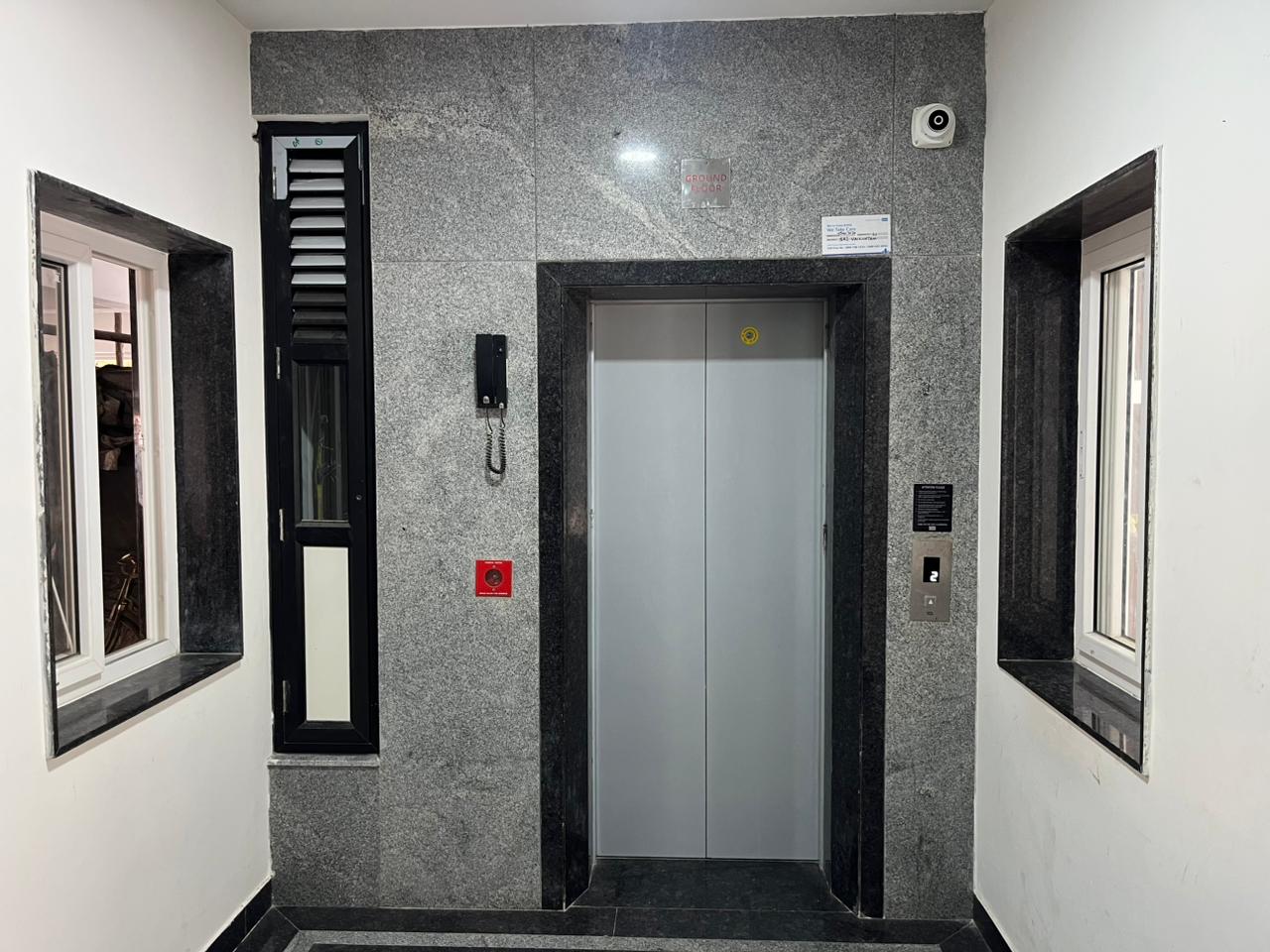

Elevators
Rain Water Harvesting

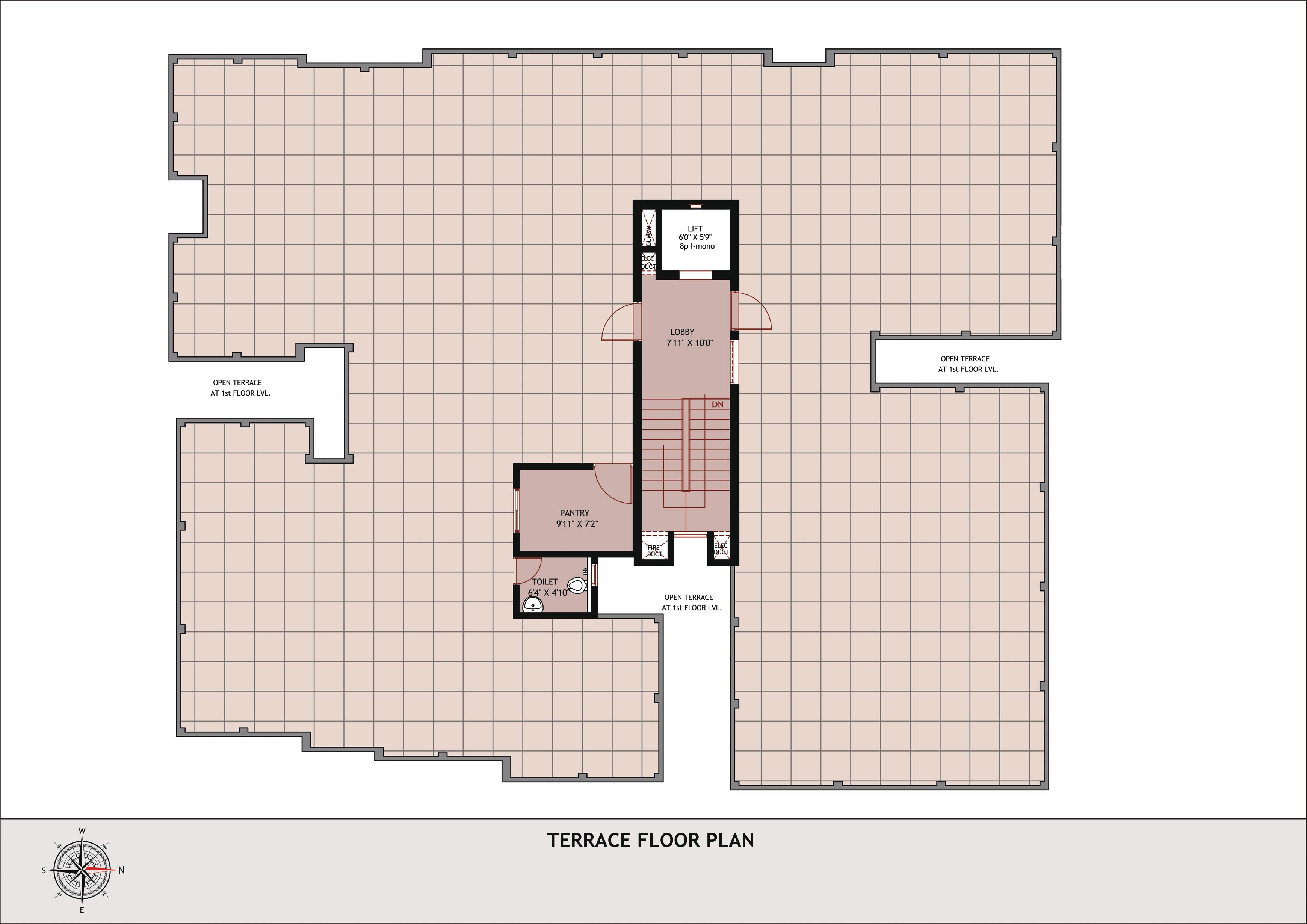

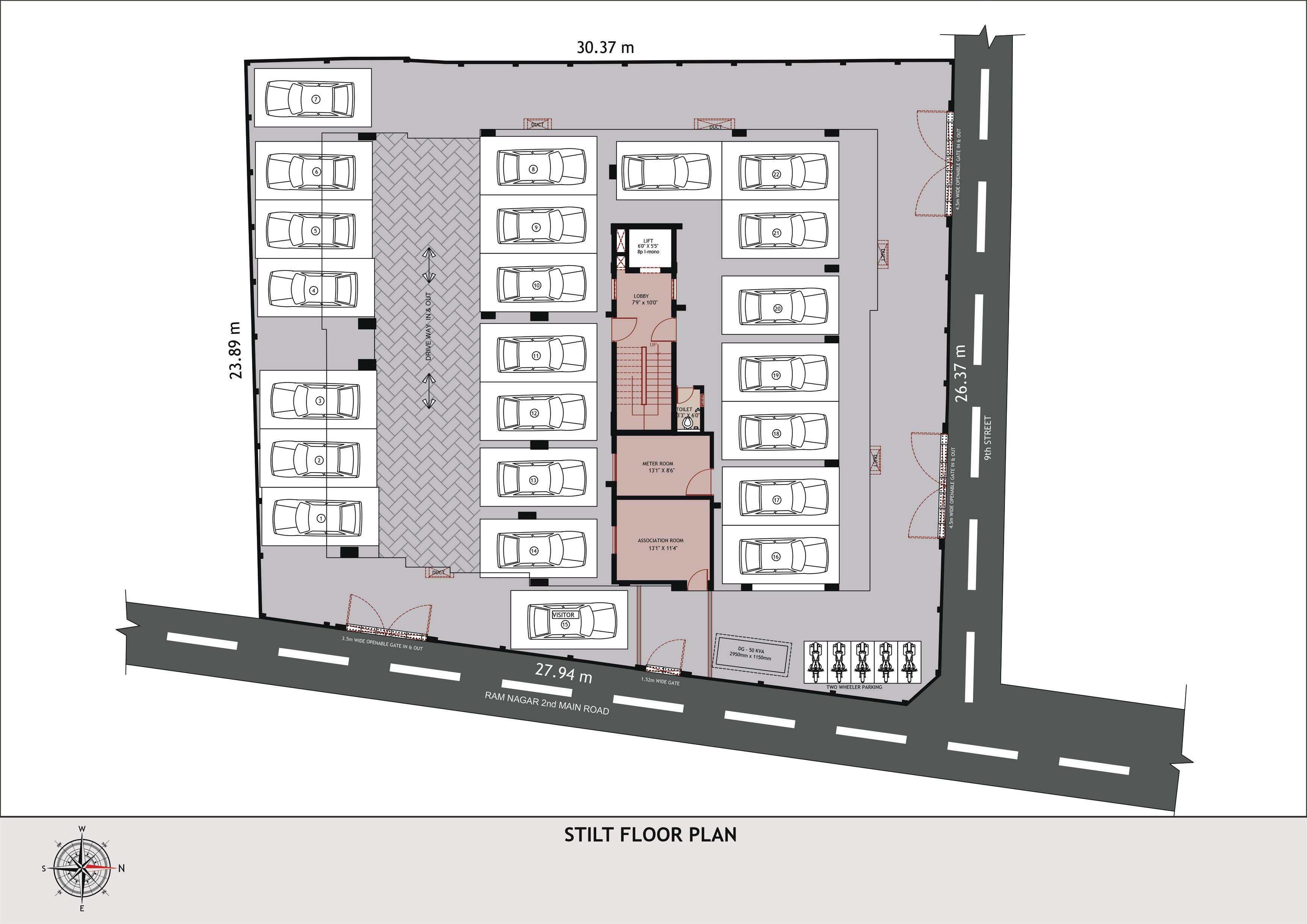

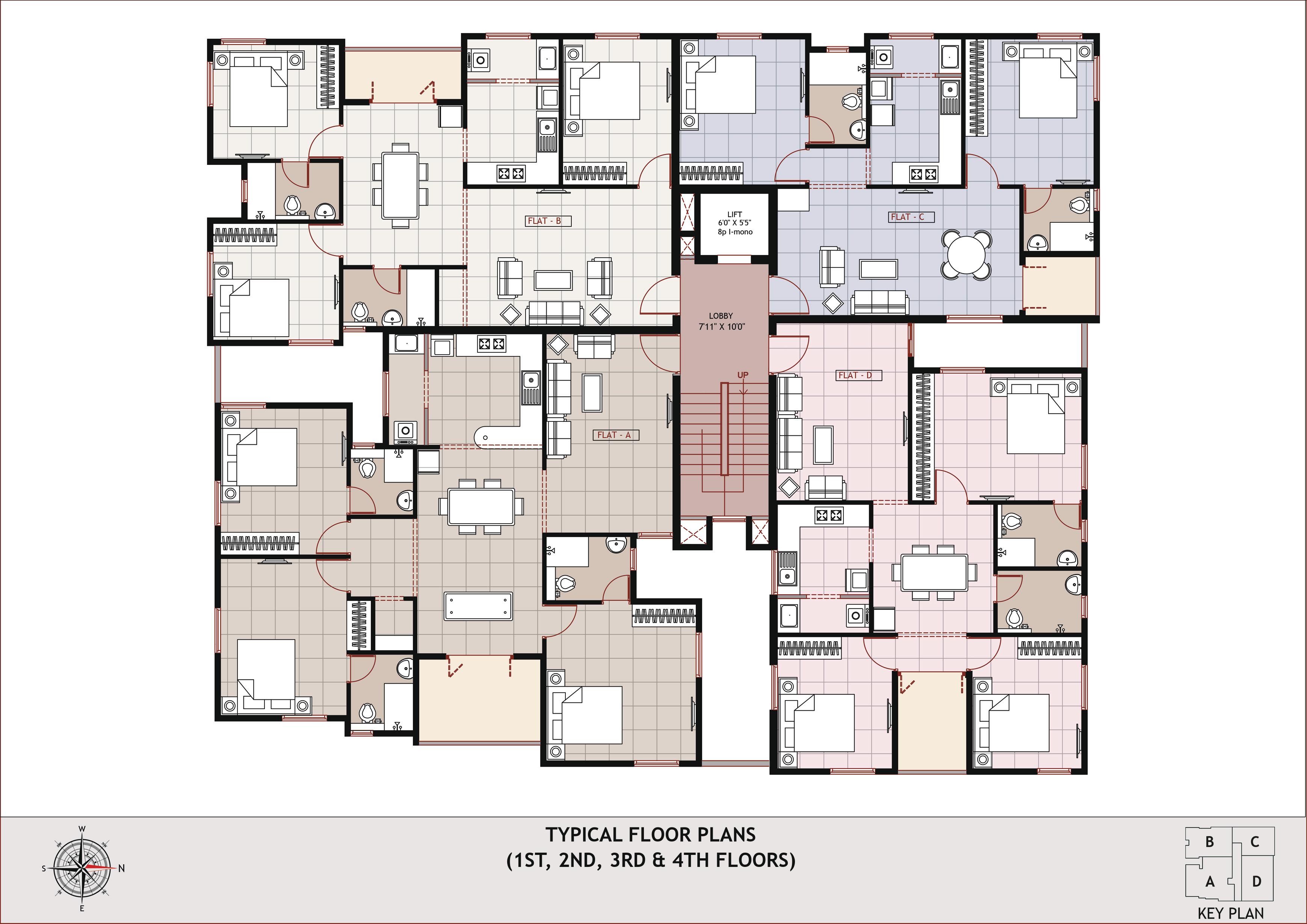

Master Layout Plan

Approvals

Planning Permit No:

OL - PP / NHRB / 0404 / 2023, Permit No. OL – 00552

Date of Permit:

2023-10-16

Building Permission No:

CEBA / WDCN12 / 00403 / 2023

Date of Permit:

2023-11-02

TNRERA:

TN / 29 / Building / 0465 / 2023

Dated:

2024-11-22

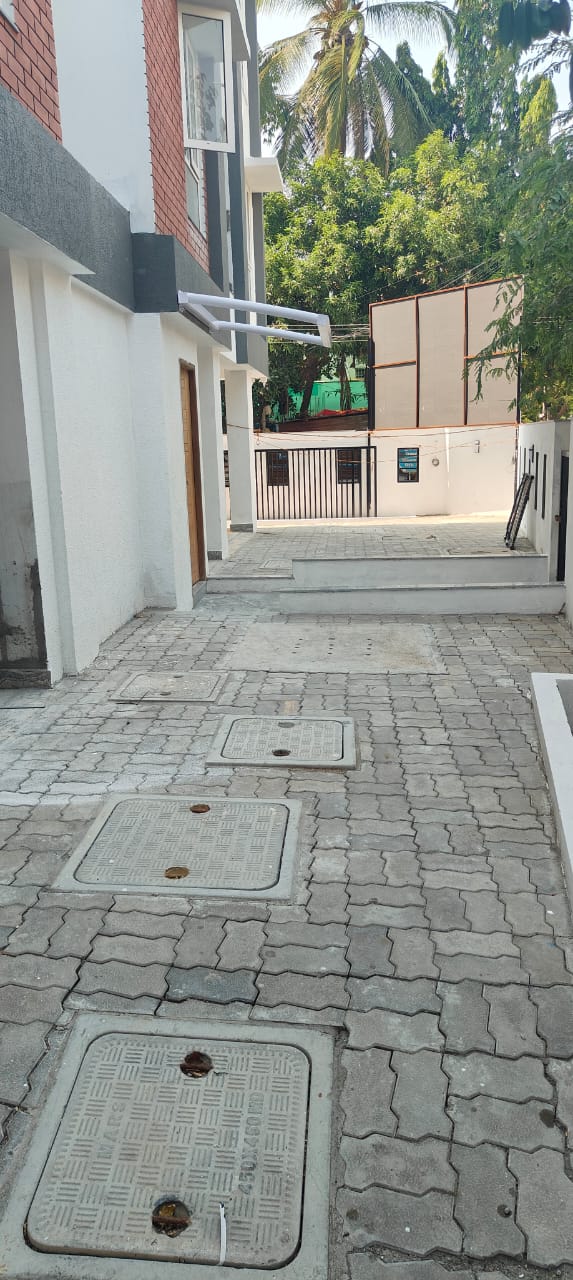

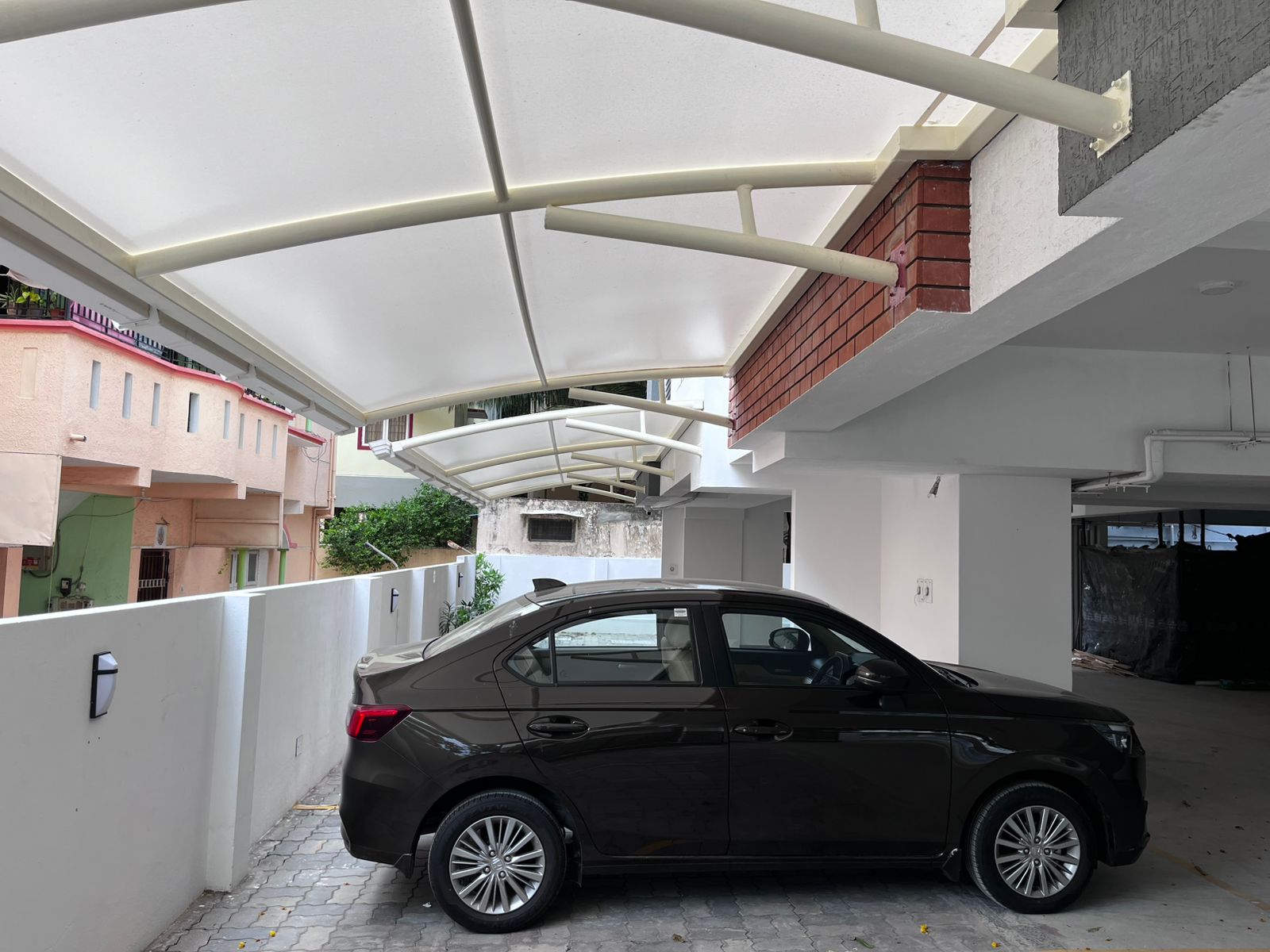

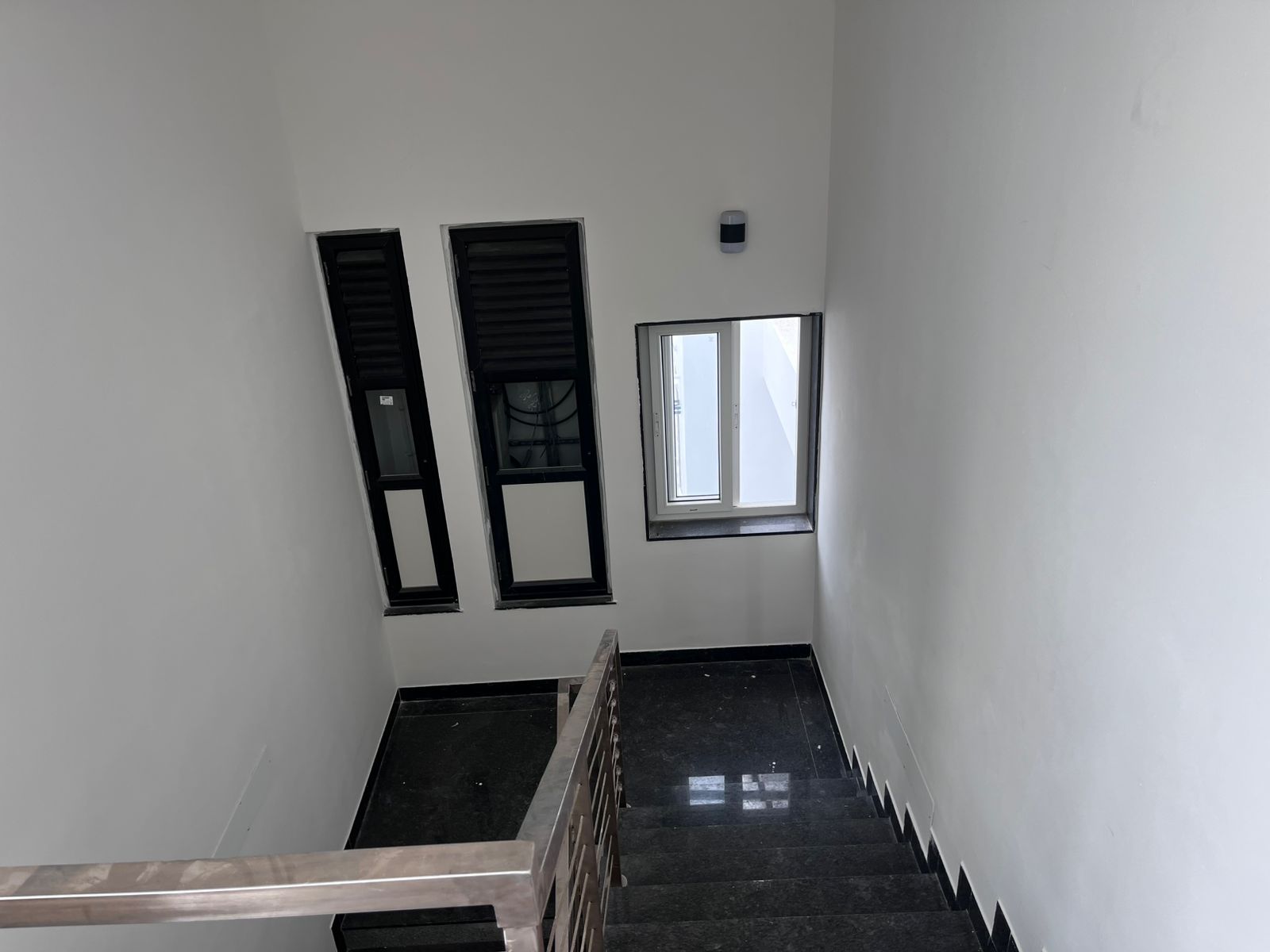

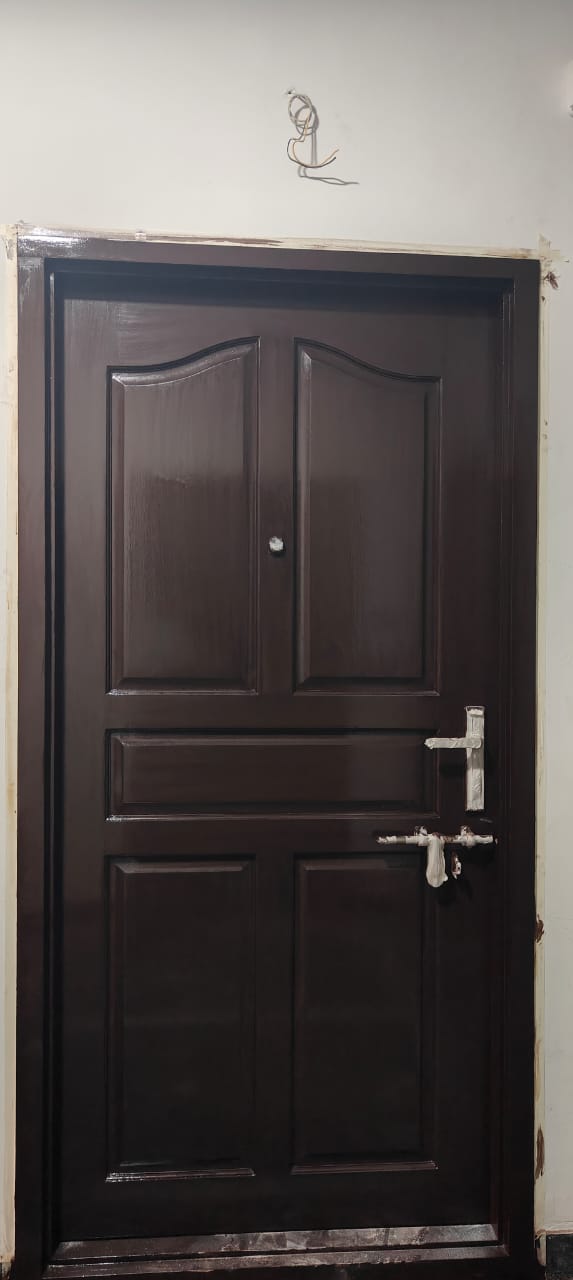

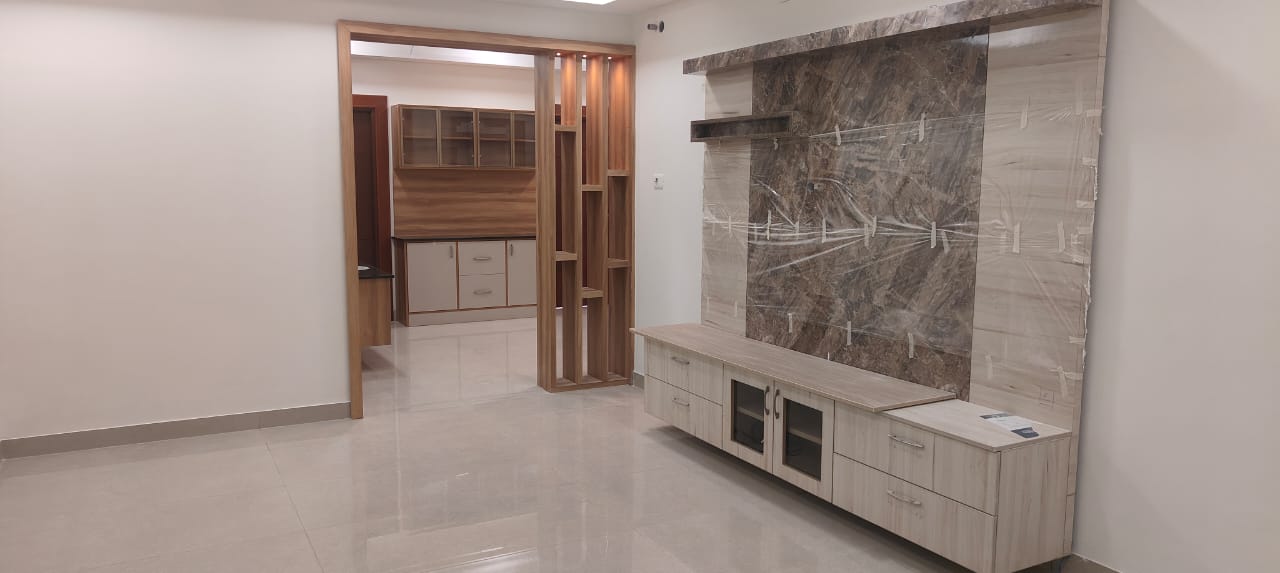

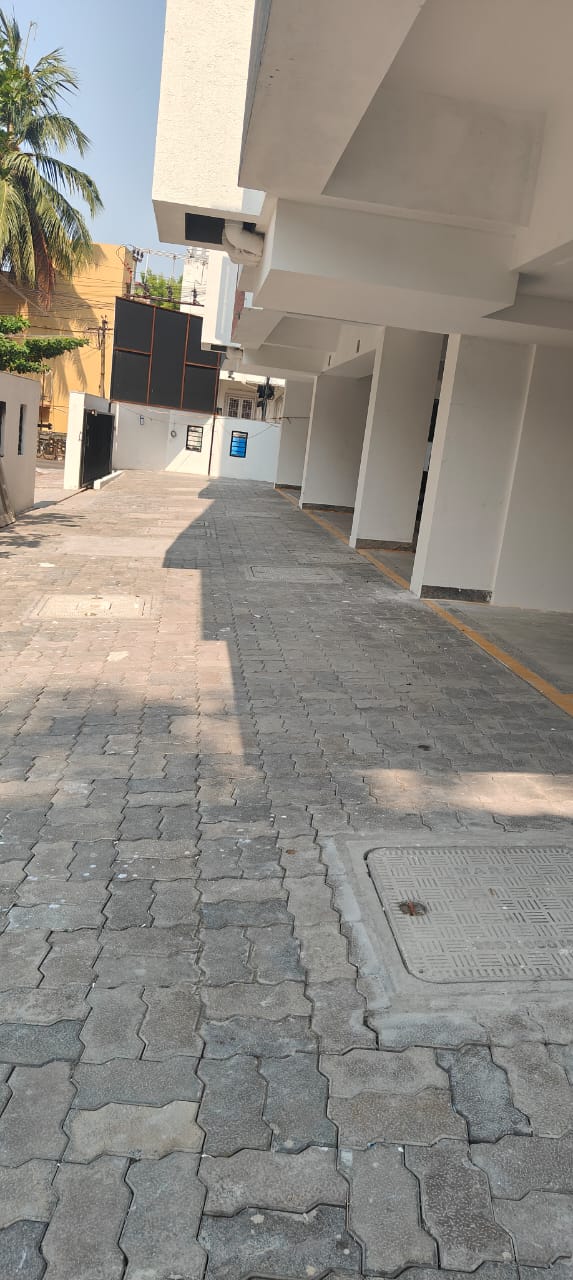

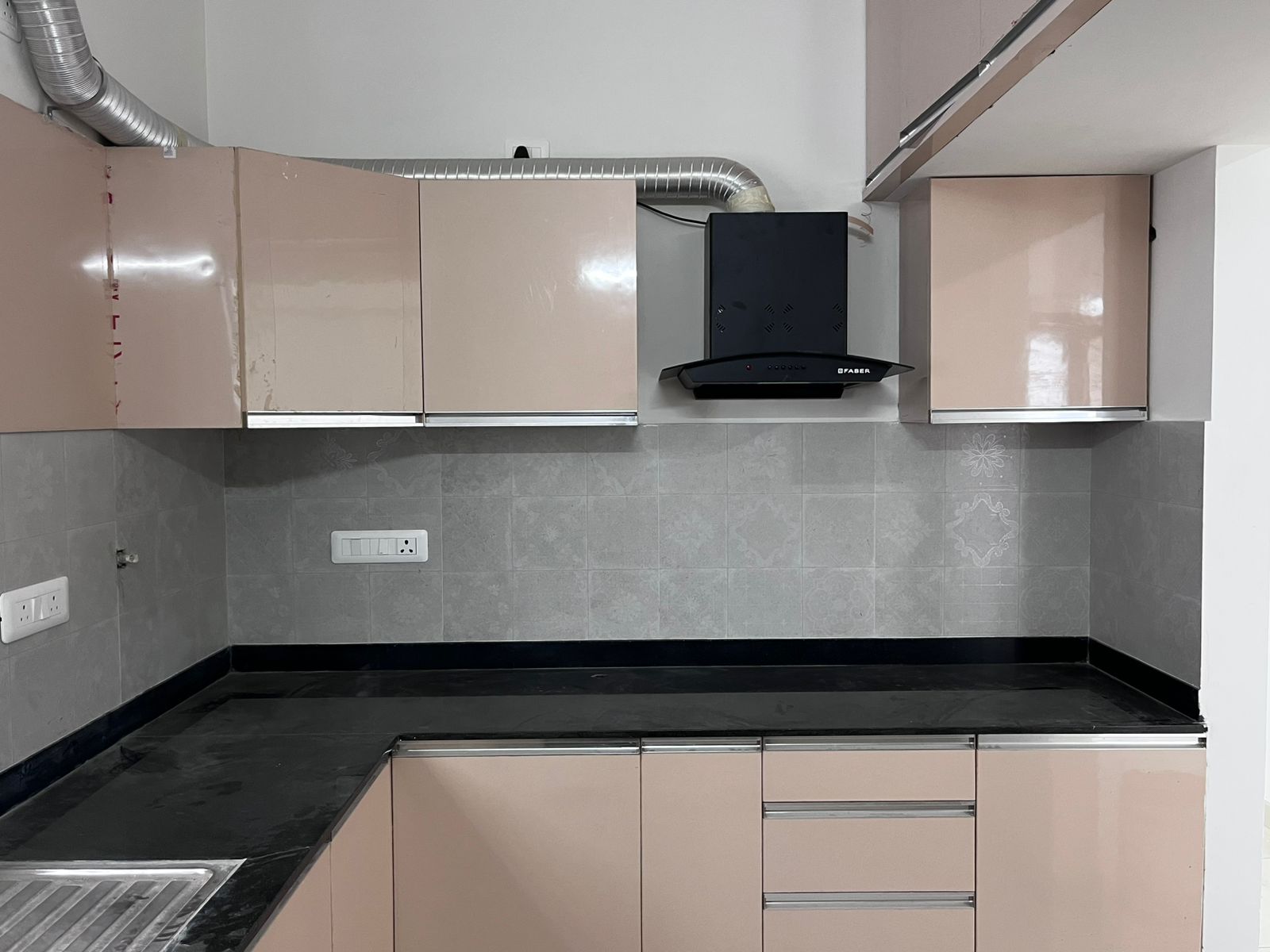

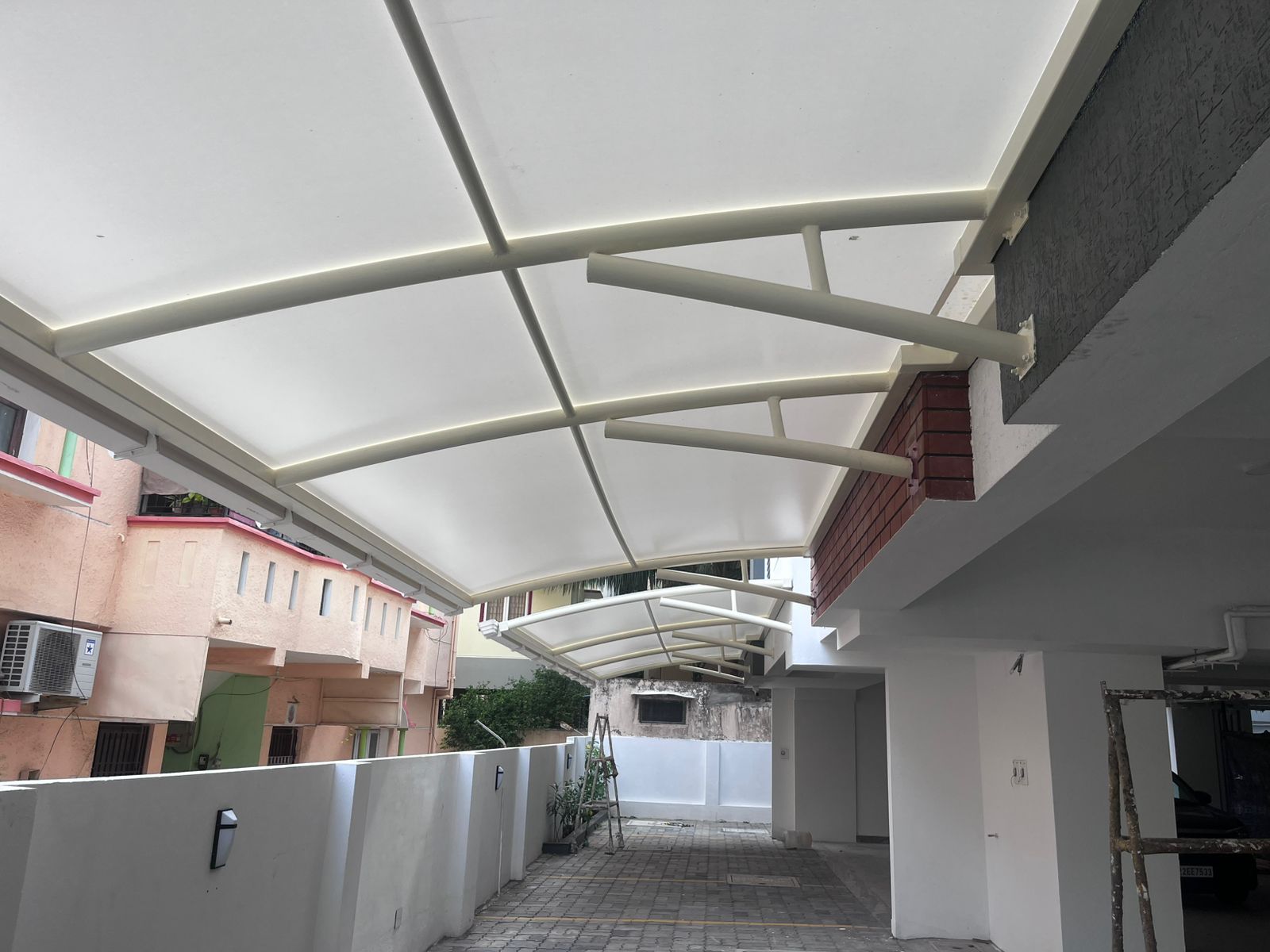

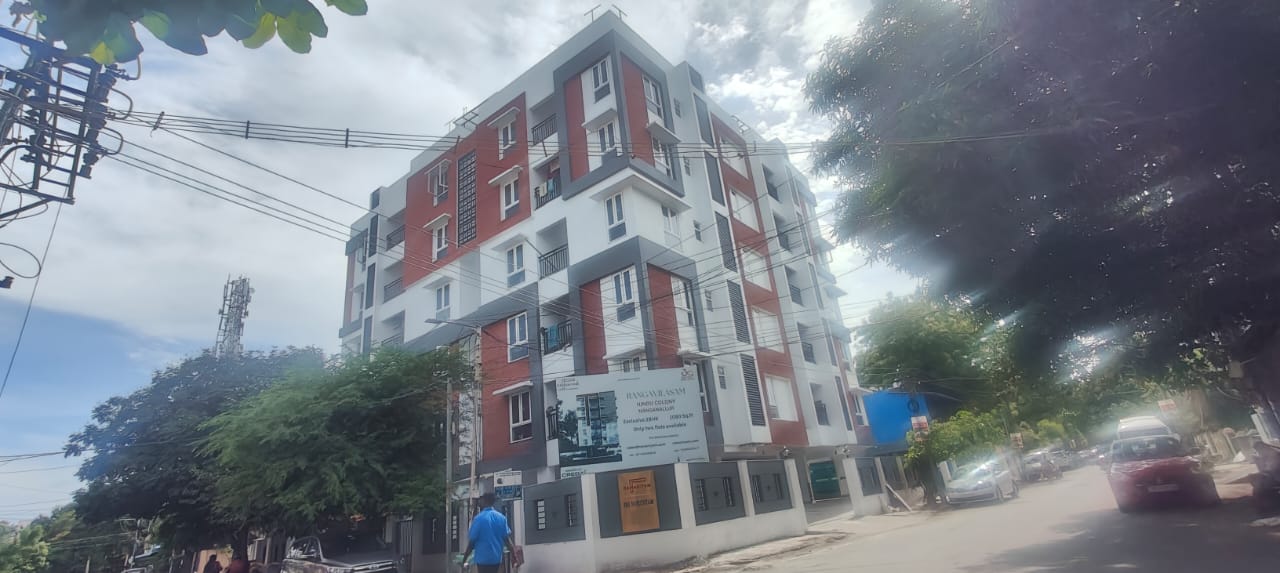

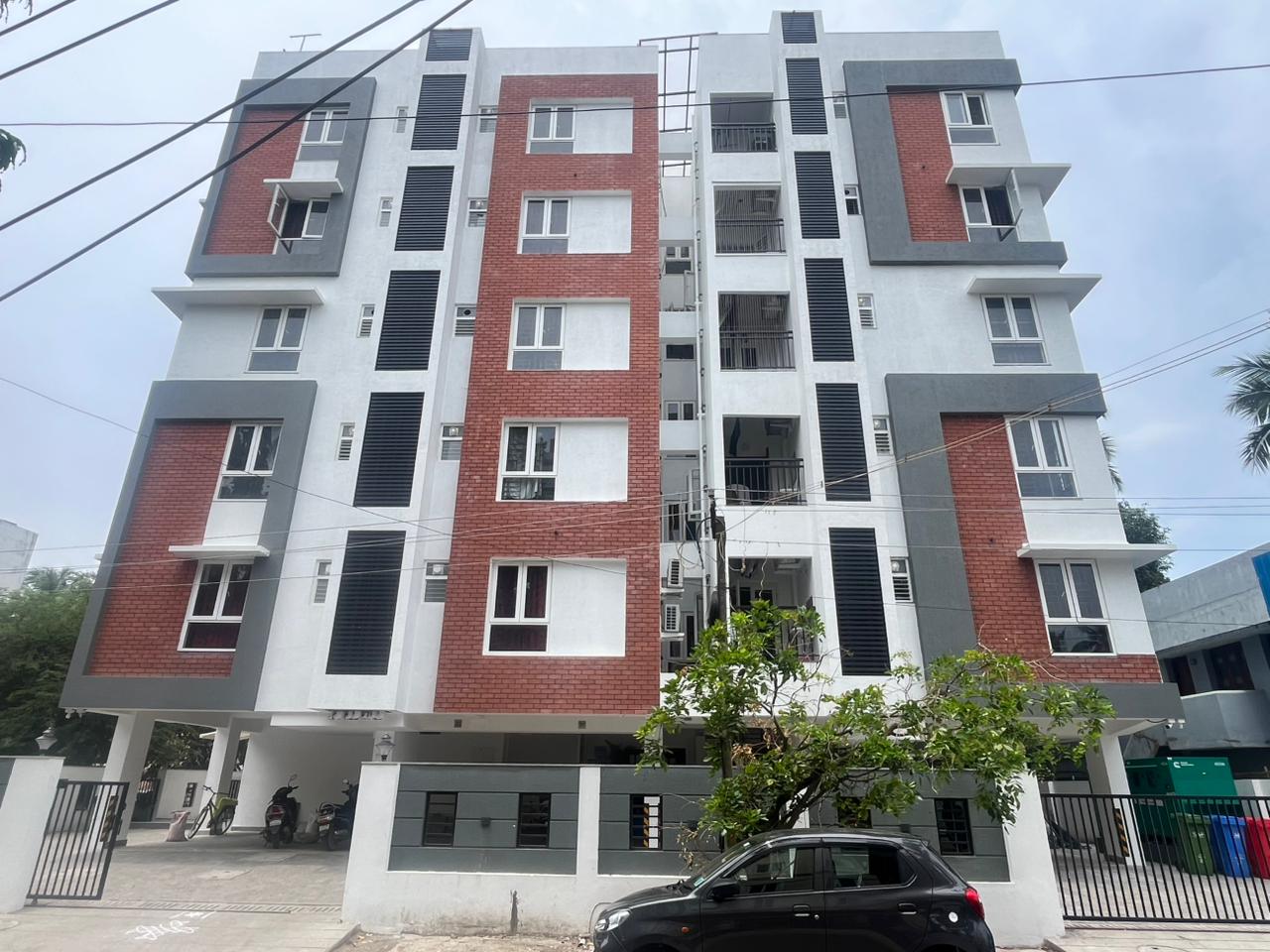

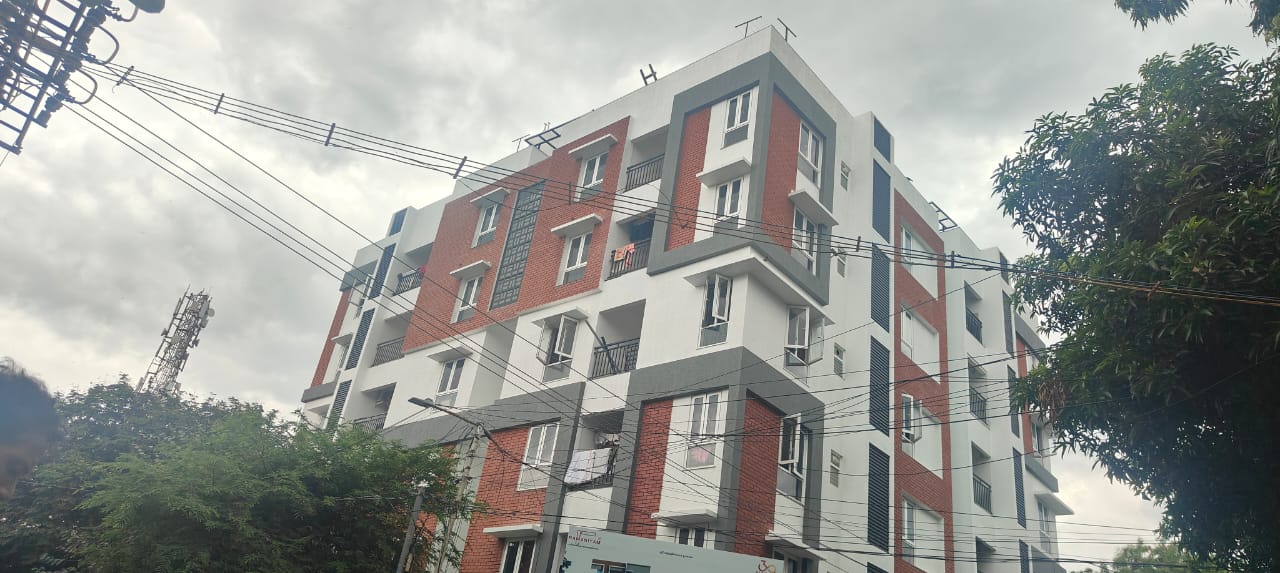

Project Update Images

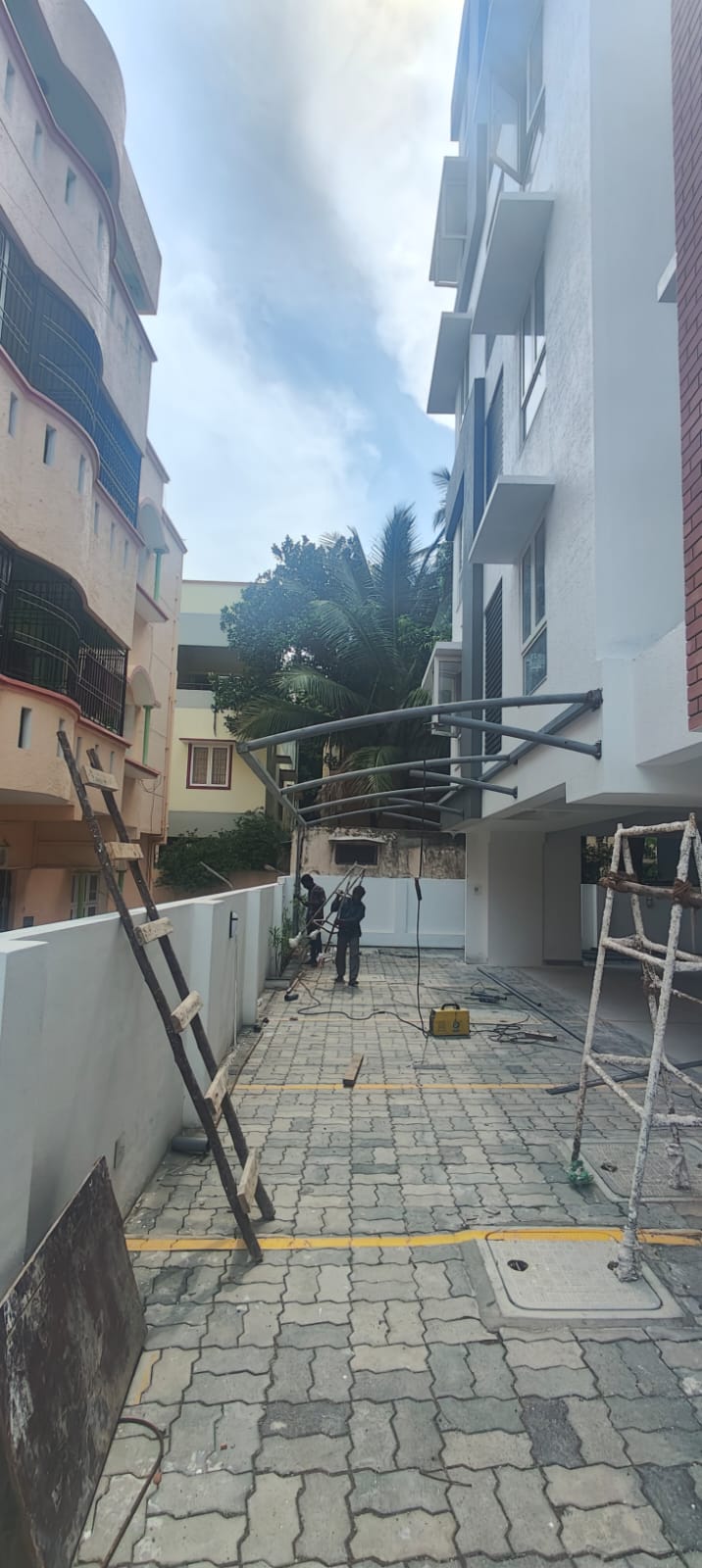

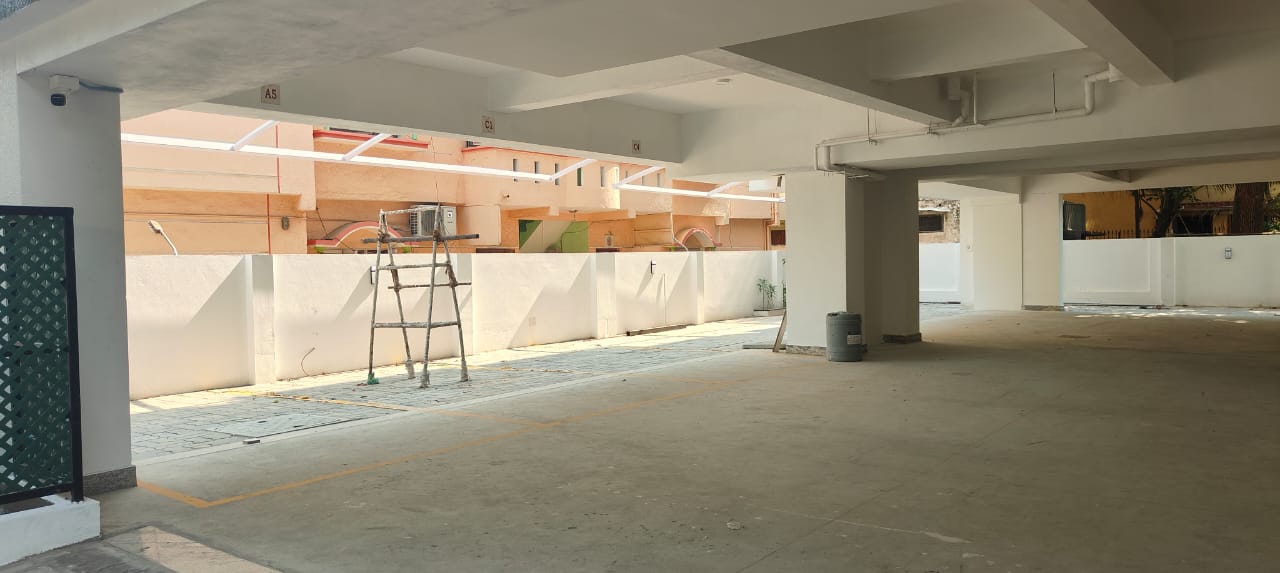

  • Stilt floor column and beam plastering work is in progress. (50% completed)
  • 5th floor toilet plumbing work is in progress.
  • Upto 3rd floor toilet wall tile laying work is in progress.(75% completed)

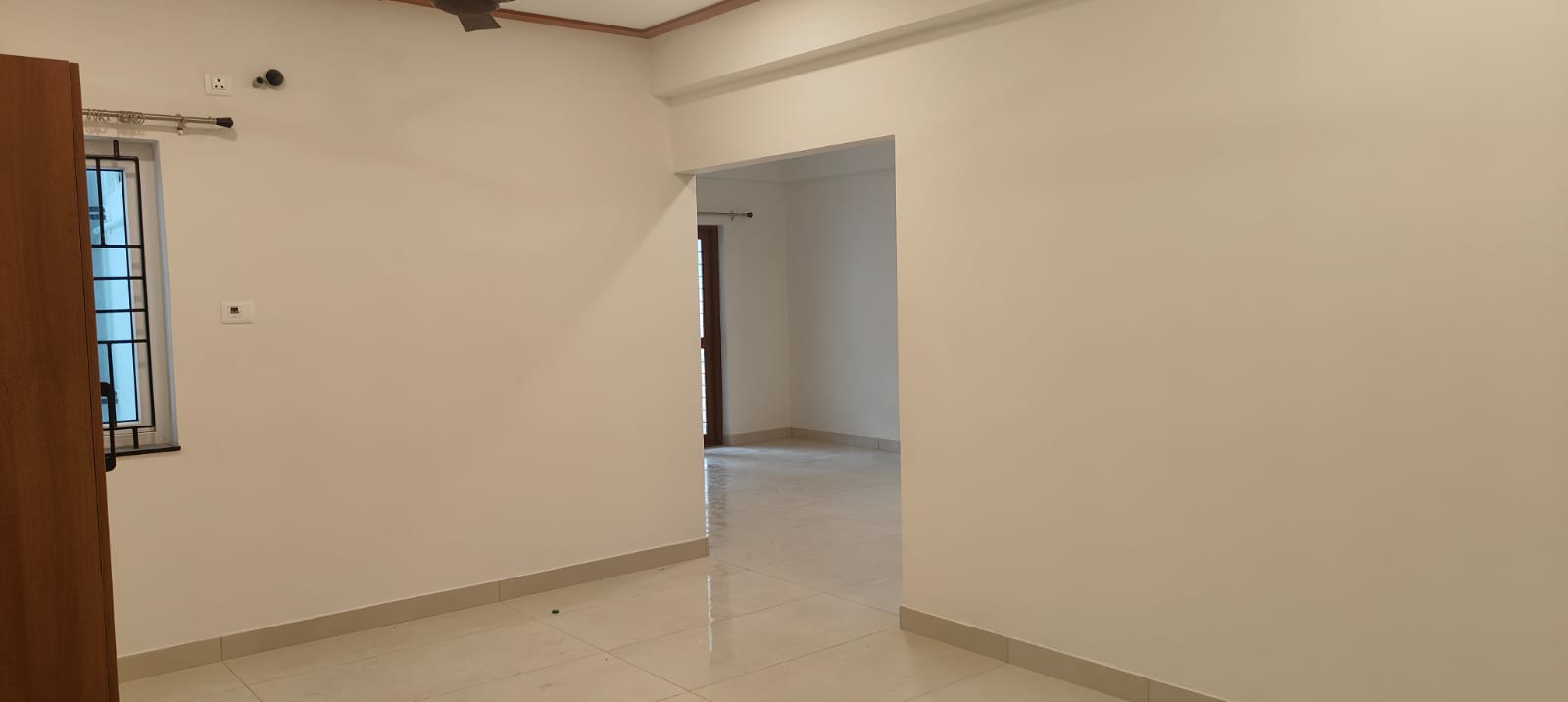

  • 1st floor general flooring work is in progress. (25% completed)
  • 2nd and 3rd floor general flooring work is in progress. (50% completed).
  • External texture painting work is in progress. (90% completed)
  • External duct plumbing work is in progress.

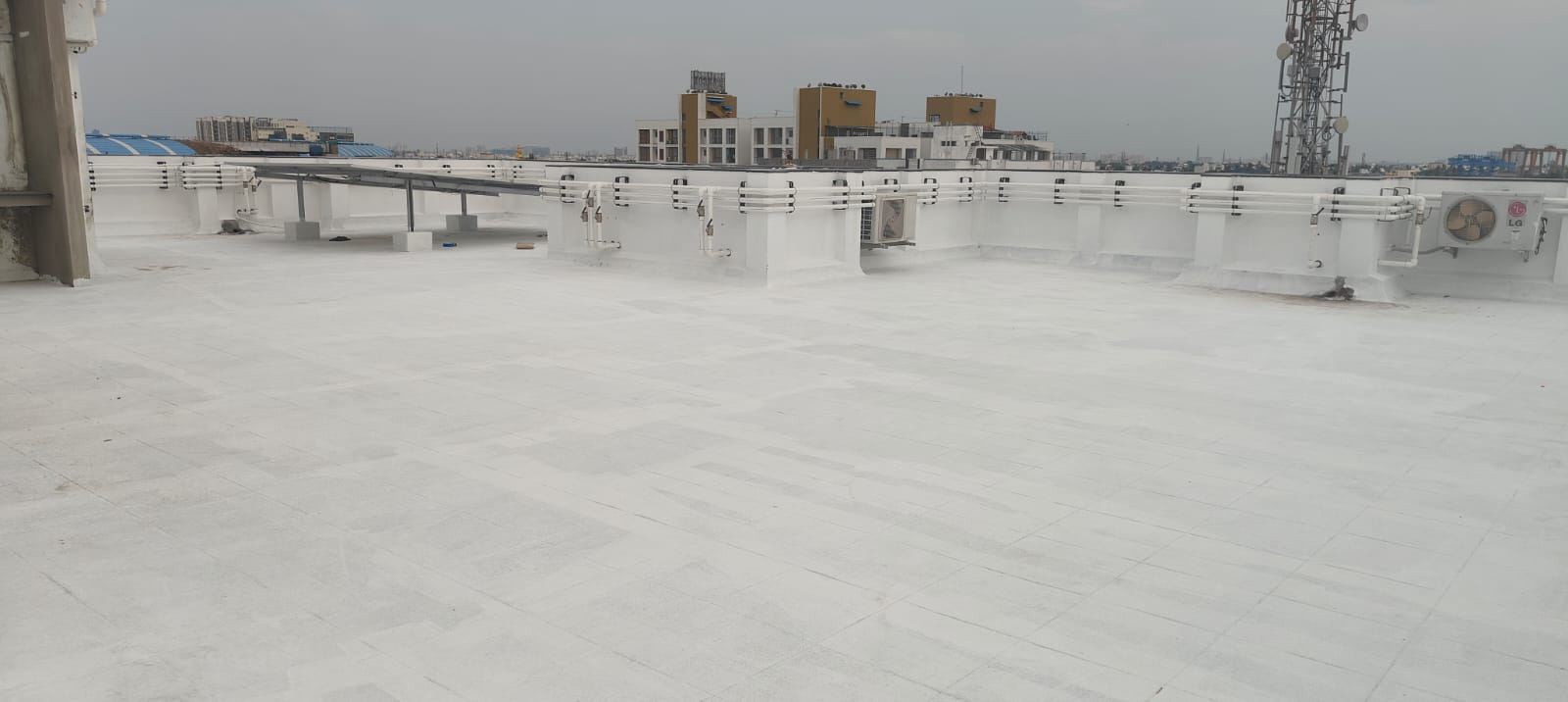

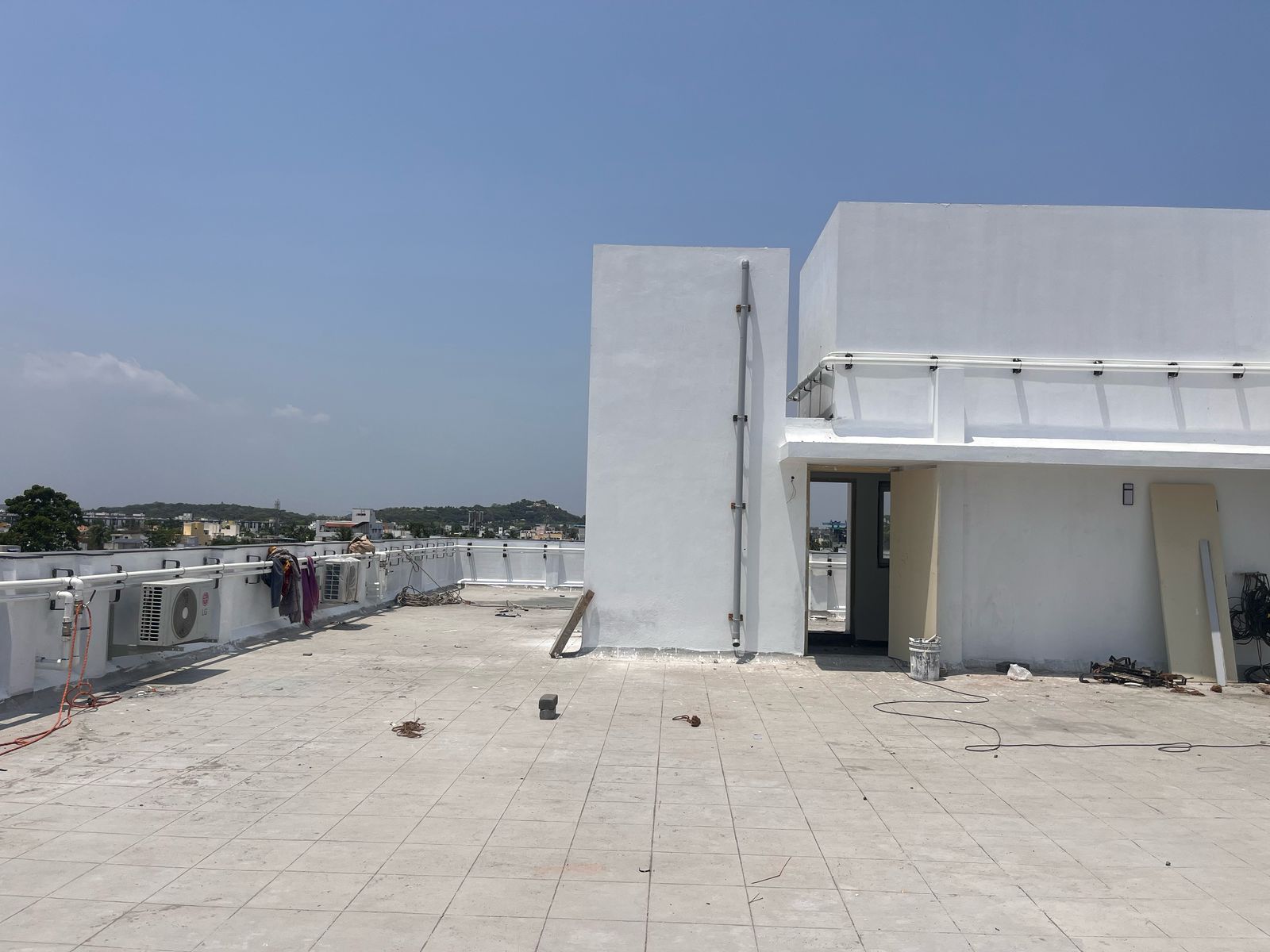

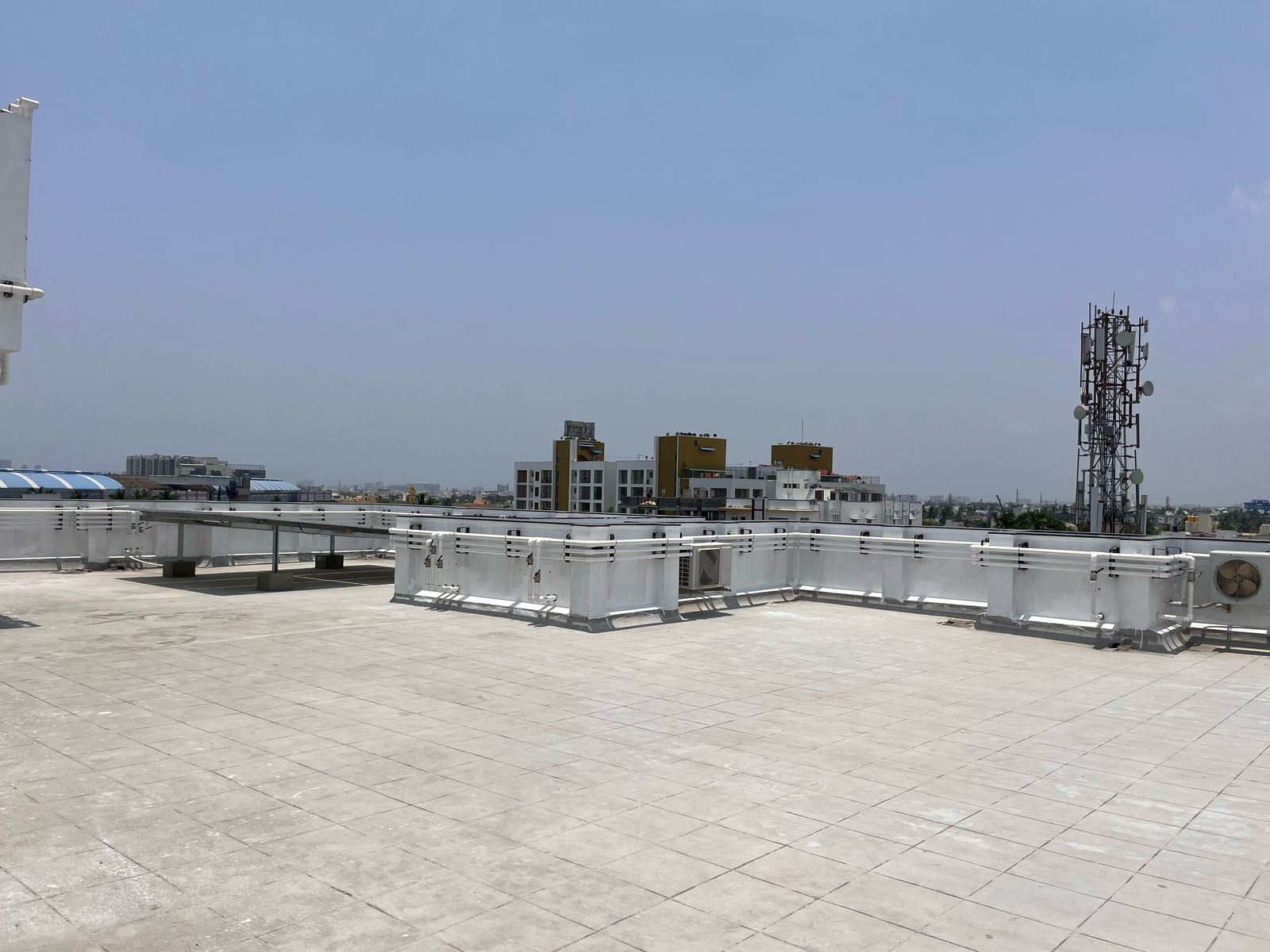

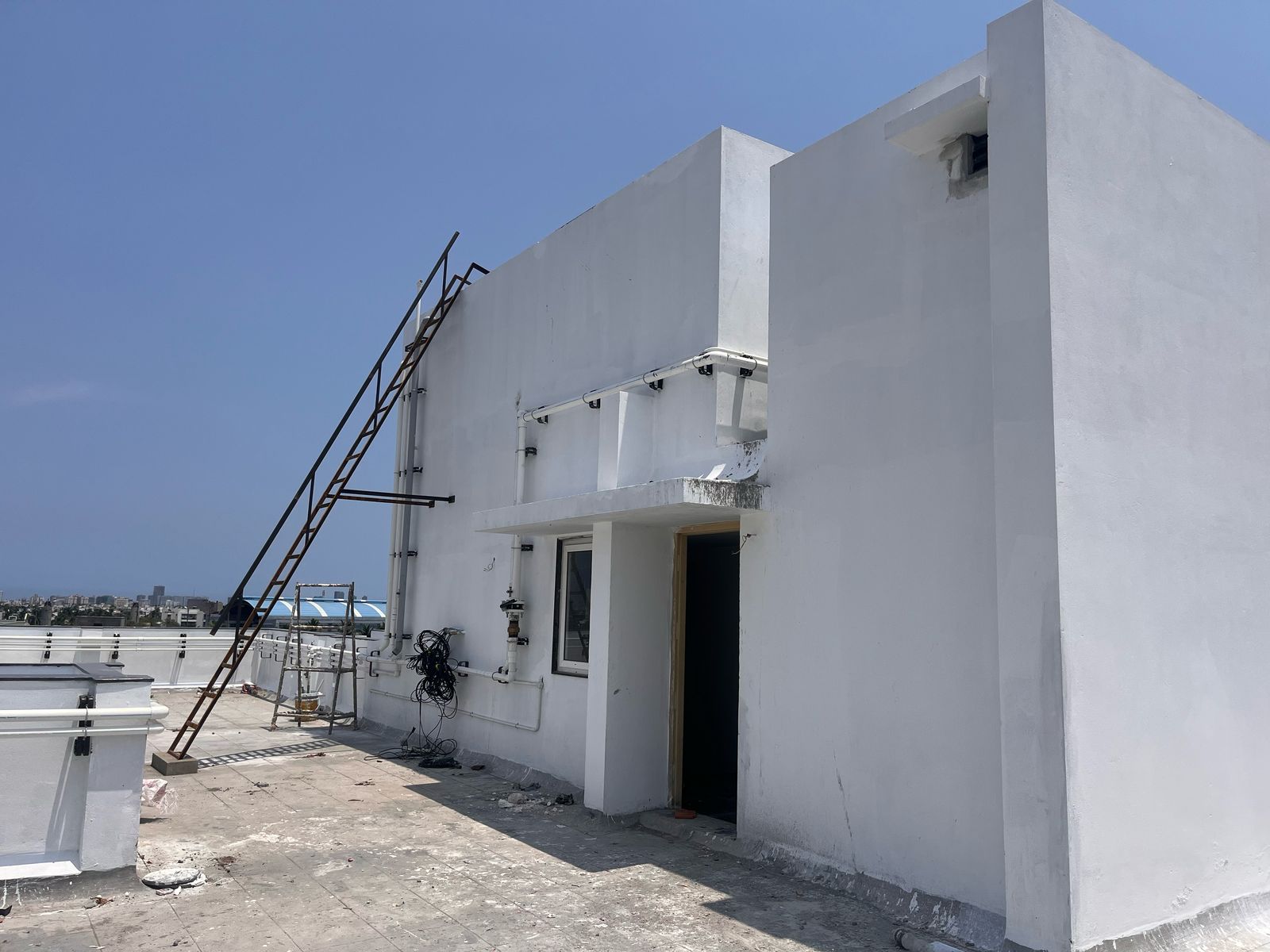

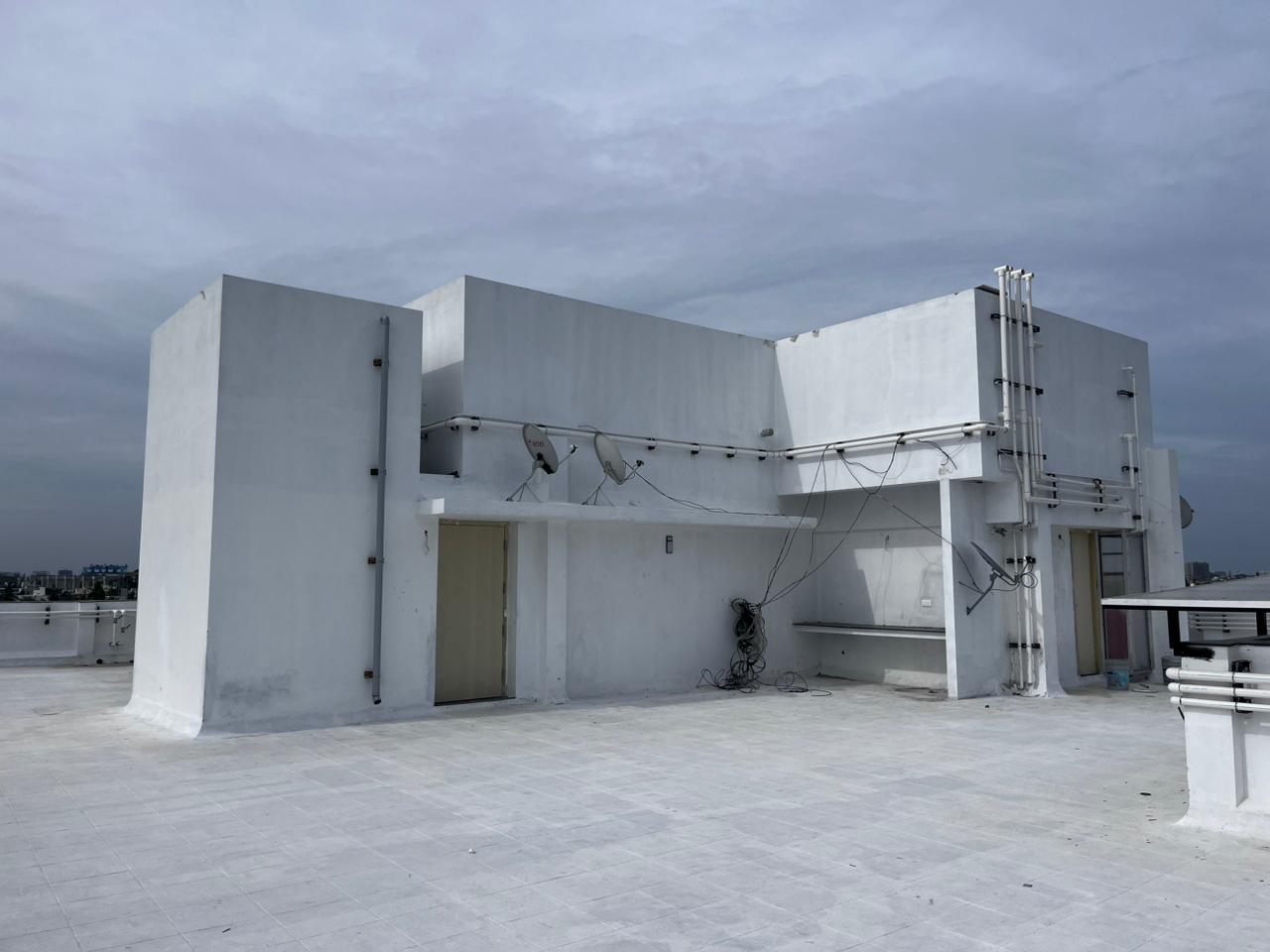

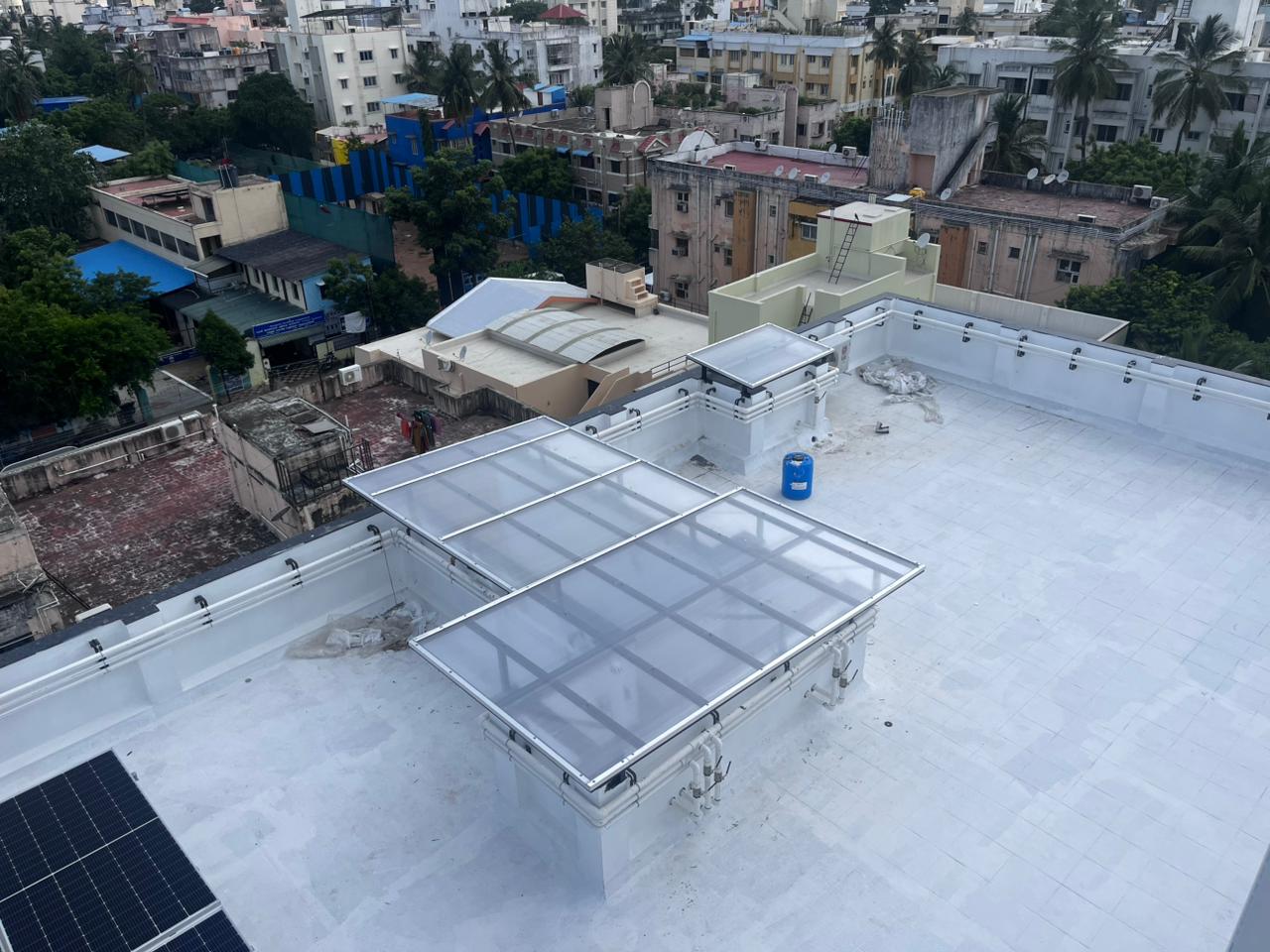

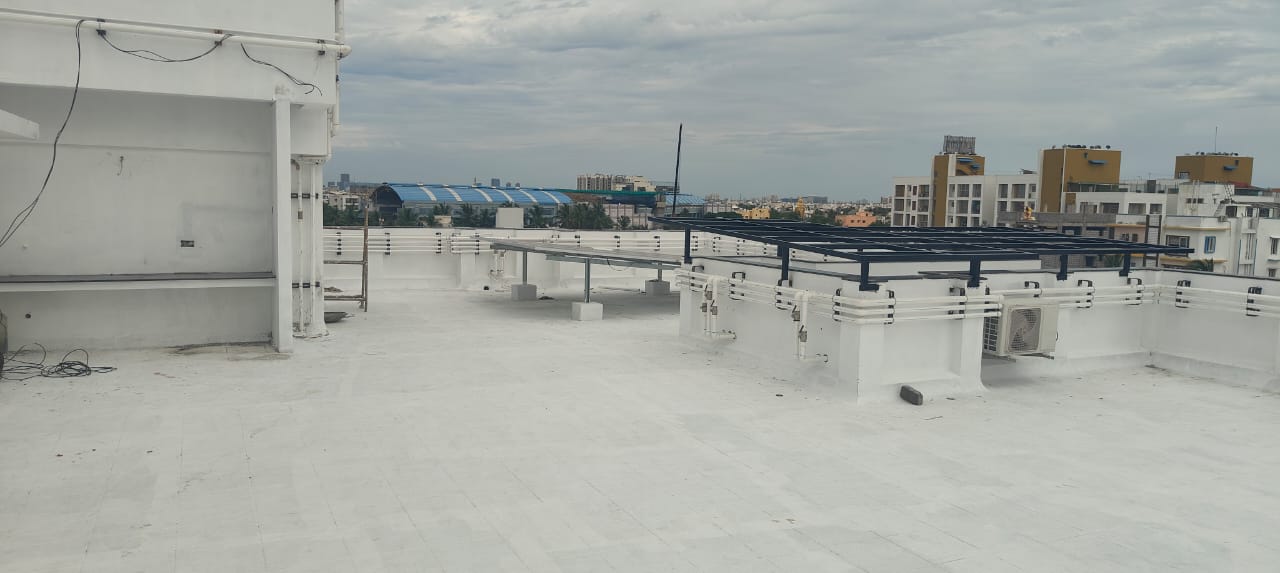

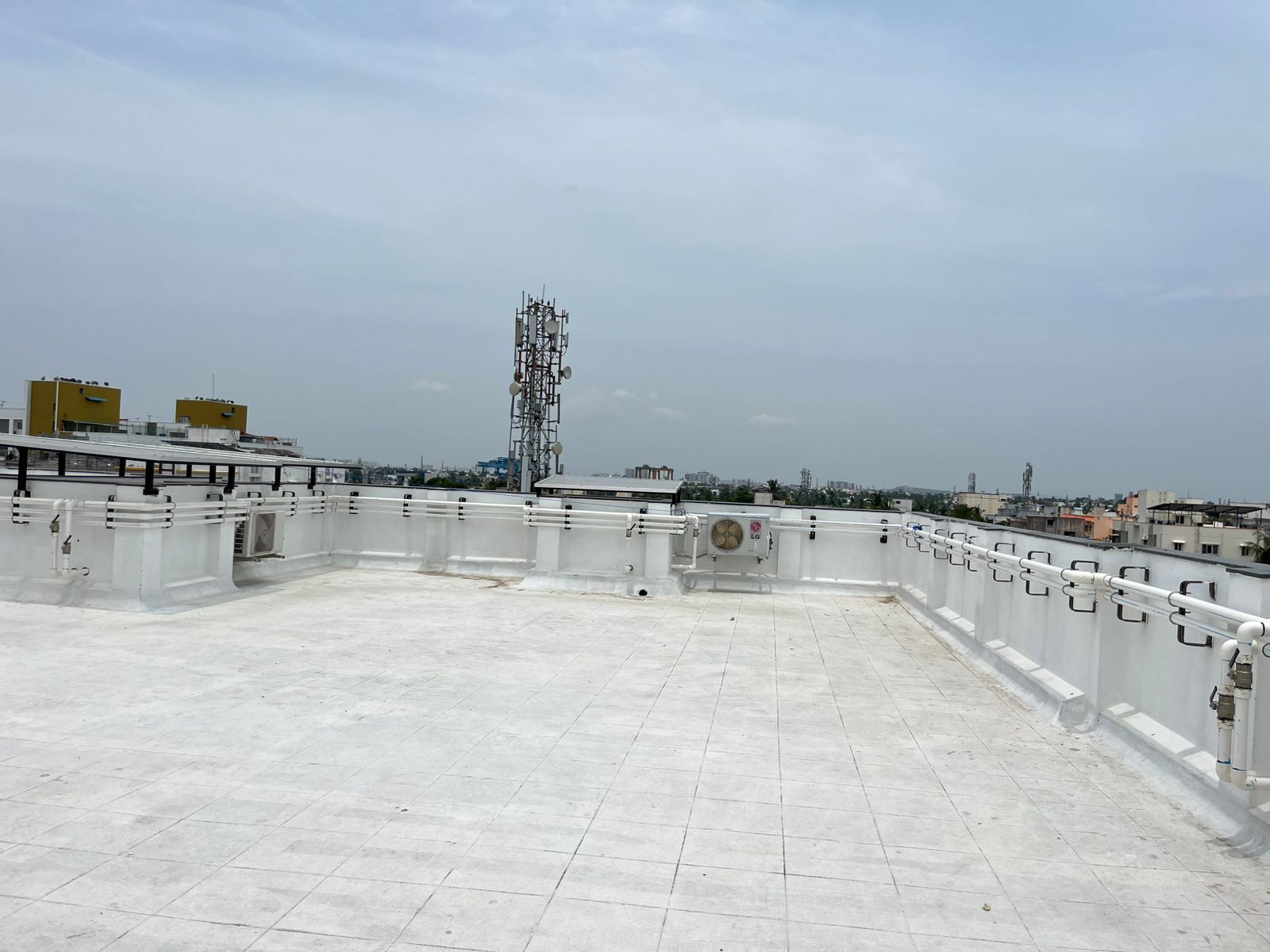

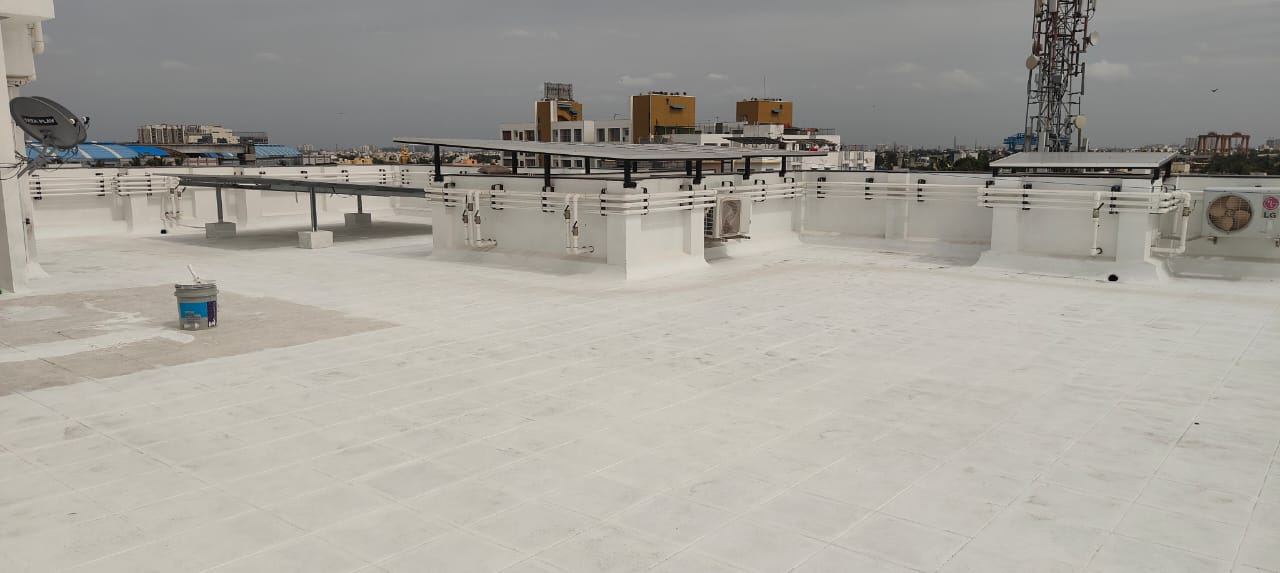

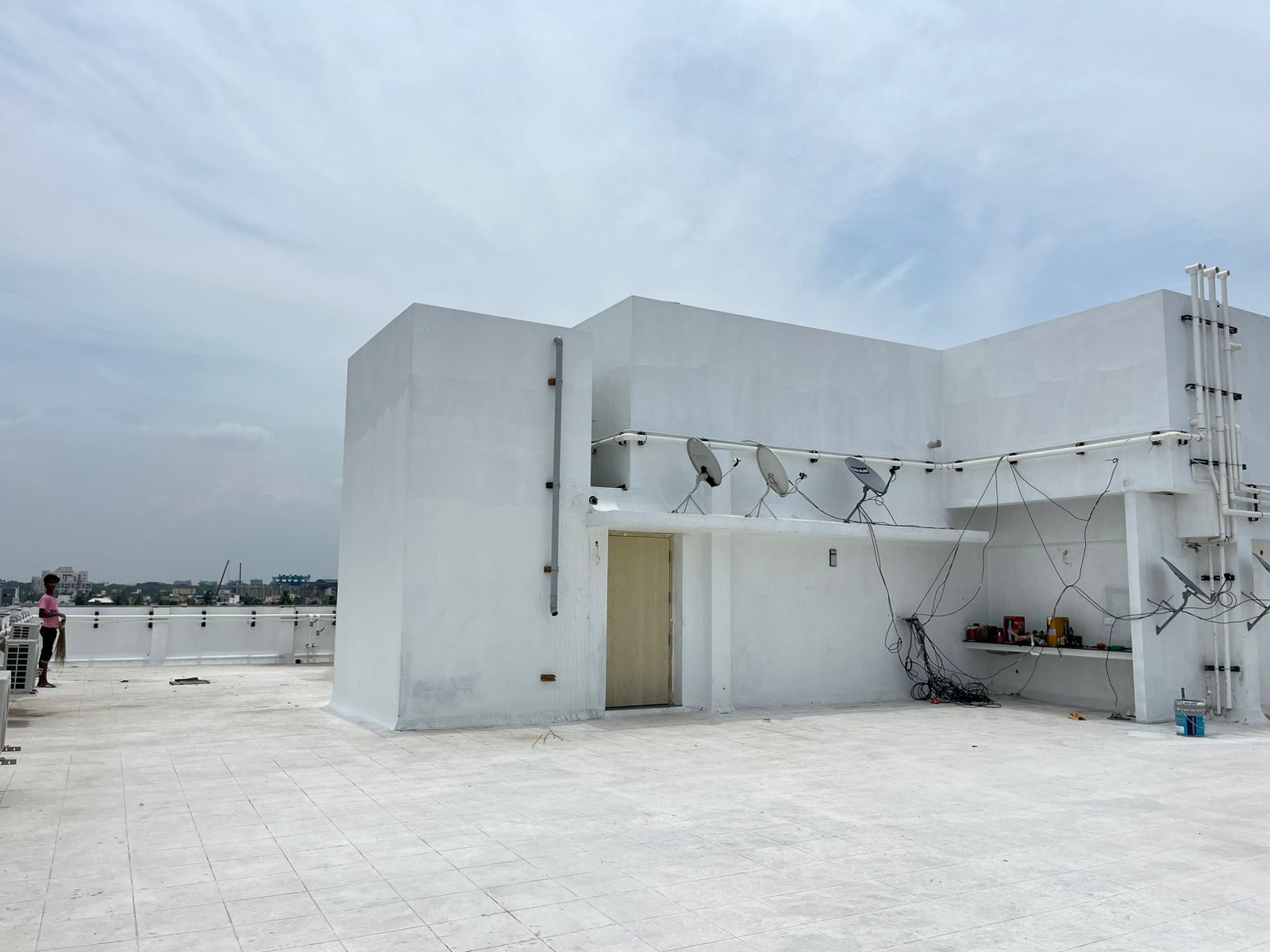

  • Terrace floor weathering course work is in progress.
  • Stilt floor column and beam plastering work is in progress. (70% completed)
  • 5th floor toilet plumbing work is in progress. (90% completed)
  • 1st and 4th floor toilet wall tile laying work is 75% completed.
  • 1st and 4th floor general flooring work is in progress. (25% completed)
  • 2nd and 3rd floor general flooring work is in progress. (50% completed).

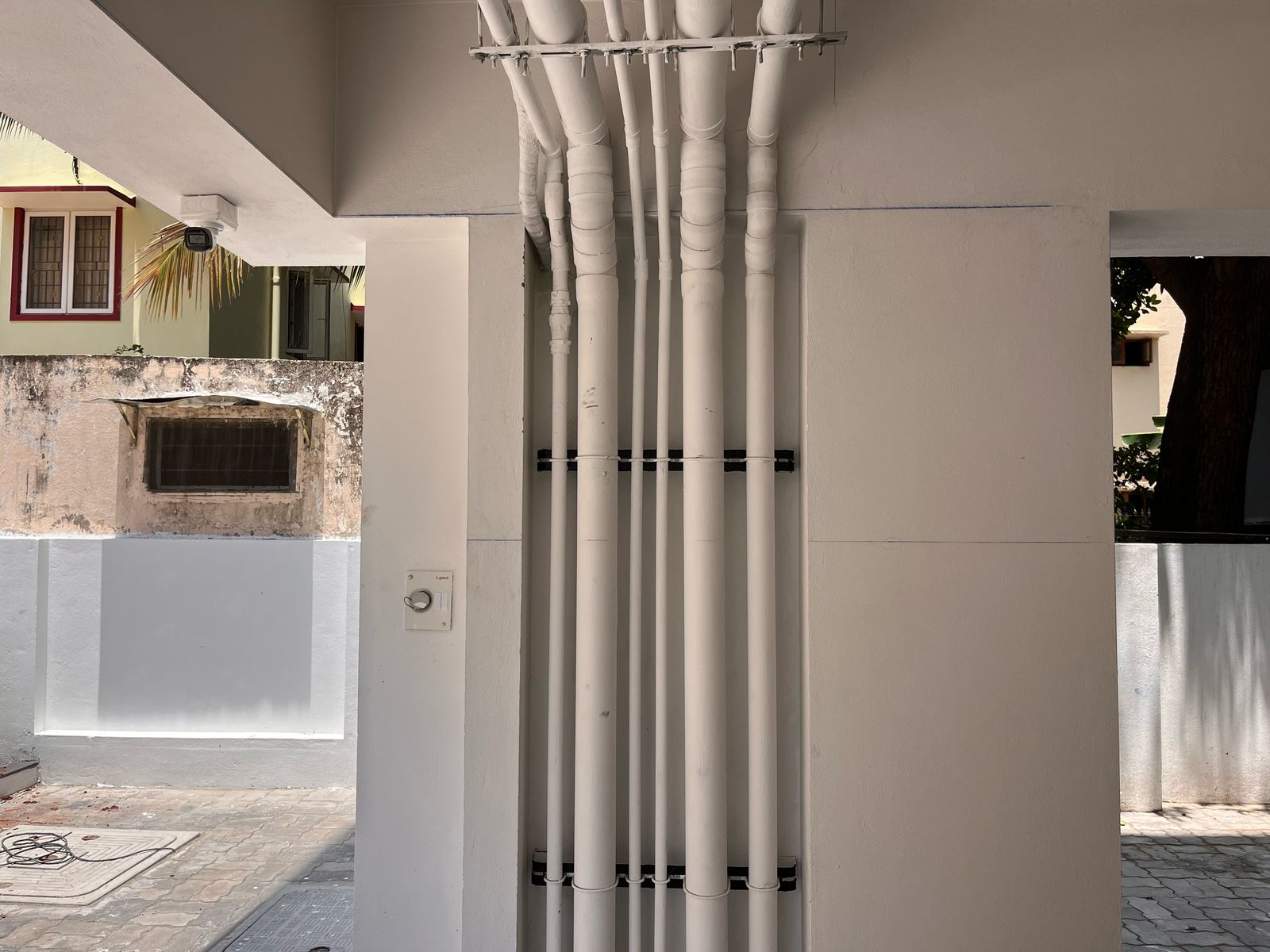

  • External duct plumbing work is in progress. (50% completed)
  • Terrace floor weathering course work is in progress. (70% completed.
  • Stilt floor column and beam plastering work is completed.
  • 5th floor toilet wall tile laying work is in progress.
  • 1st floor general flooring work is in progress. (25% completed)
  • 2nd and 3rd floor general flooring work is in progress. (75% completed).
  • 4th floor general flooring work is in progress. (50% completed).
  • External duct plumbing work is in progress. (50% completed)

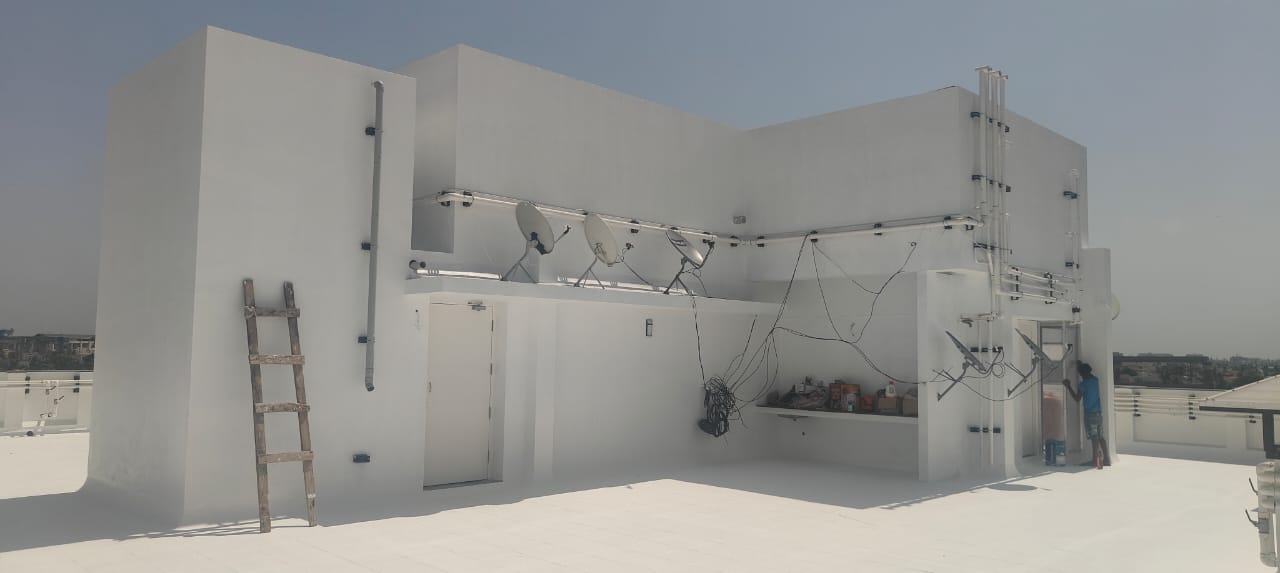

  • Terrace floor weathering course work is in progress. (80% completed.
  • 5th floor toilet wall tile laying work is in progress. (70% completed)
  • 1st & 5th floor general flooring work is in progress. (25% completed)
  • 2nd, 3rd & 4th floor general flooring work is in progress. (75% completed).
  • External duct plumbing work is in progress. (50% completed)
  • Terrace floor weathering course work is in progress. (80% completed.

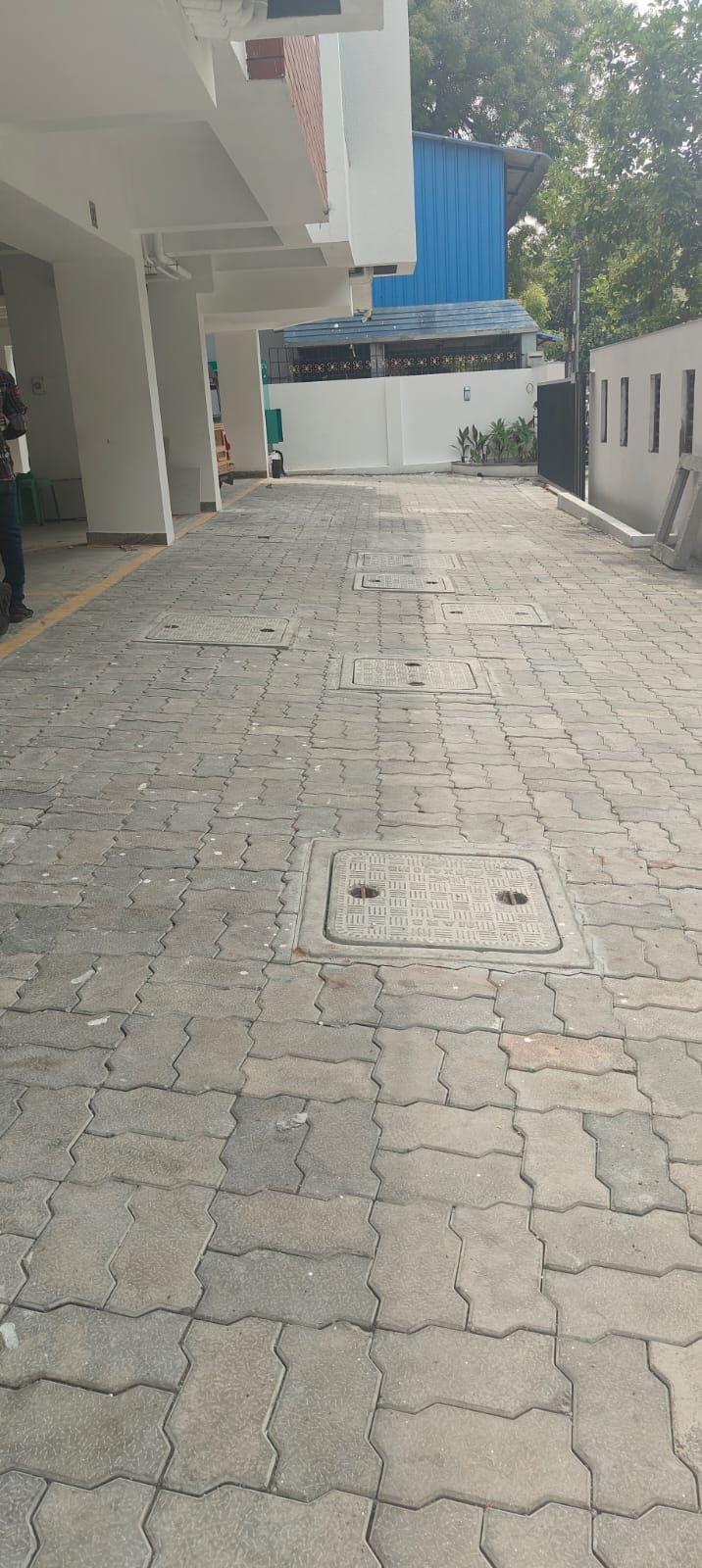

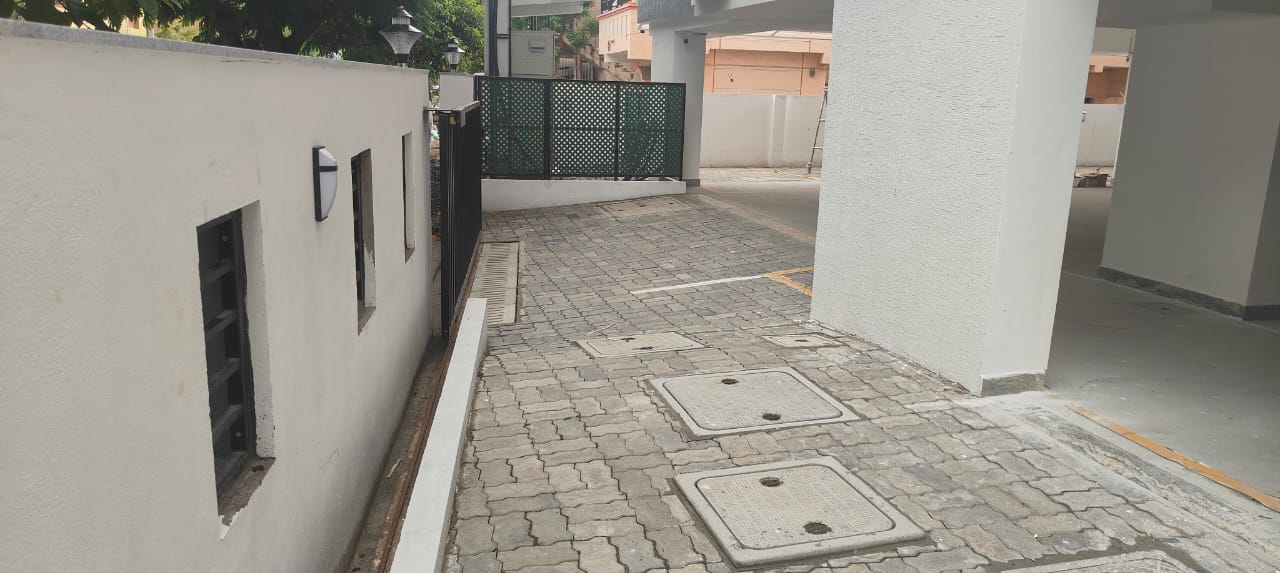

  • External chamber work is in progress. (25% completed)

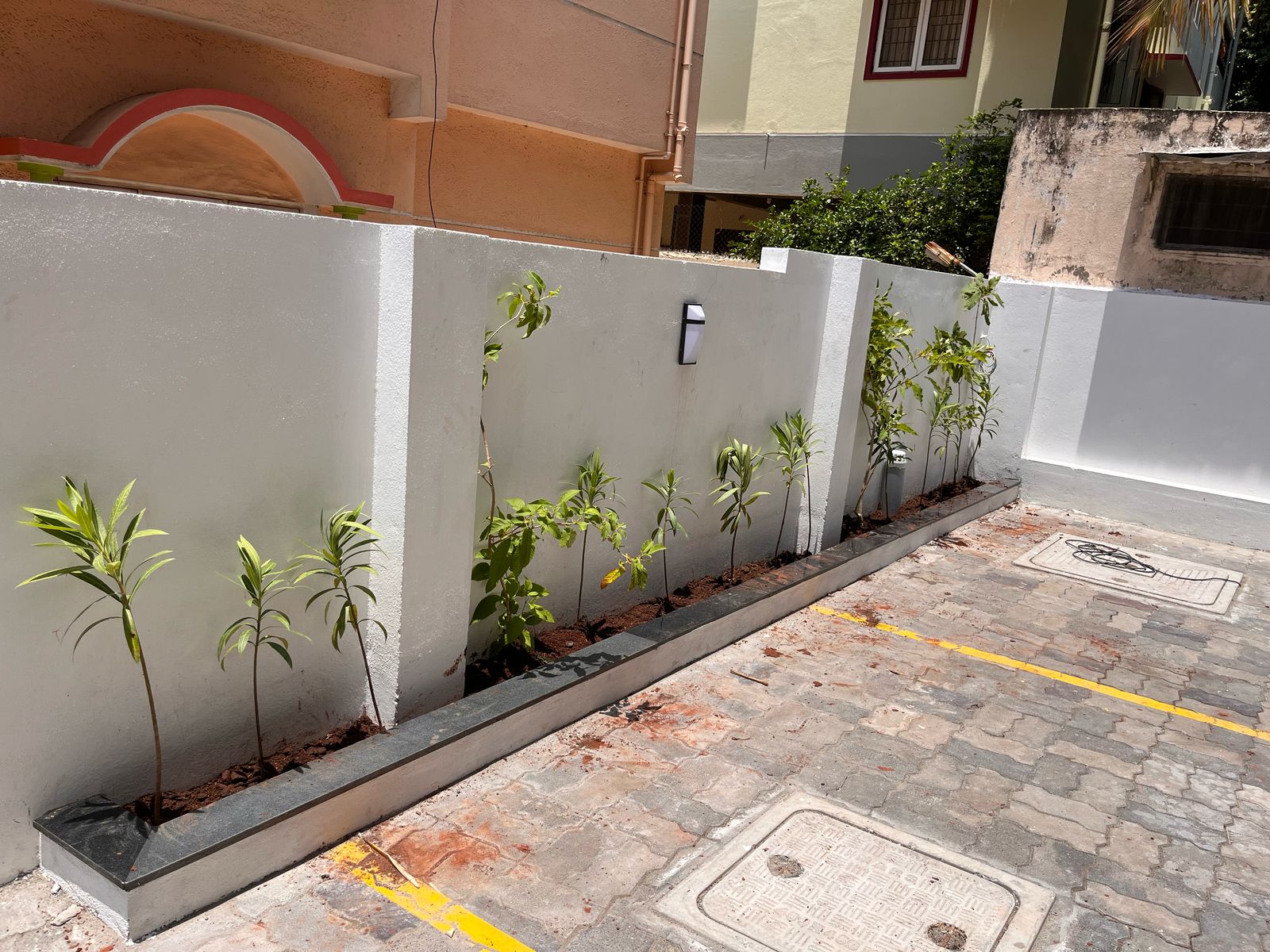

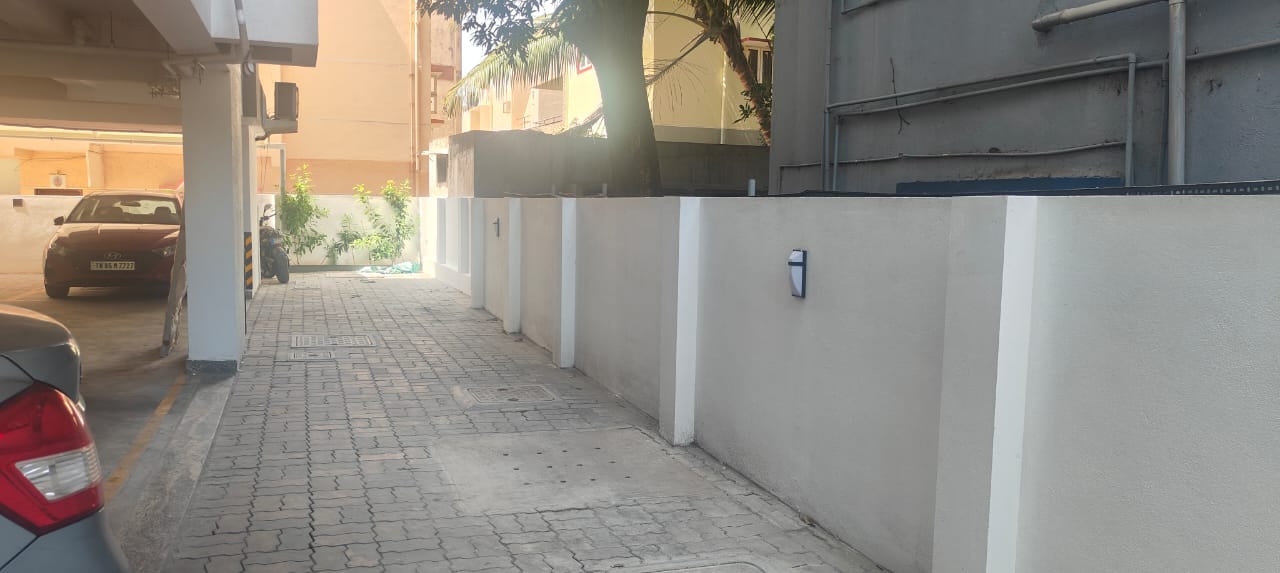

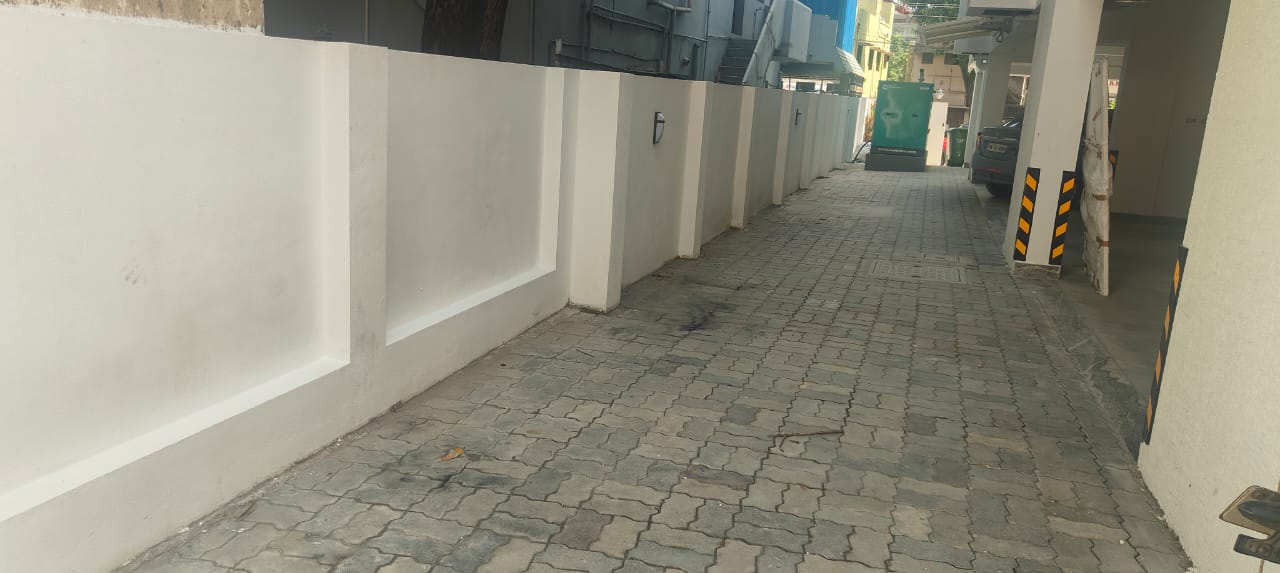

  • Compound wall brick work is in progress.
