Sastha

Mahalingapuram

Enquire Now

Amenities

Elevators
24/7 Power Backup
Rain Water Harvesting

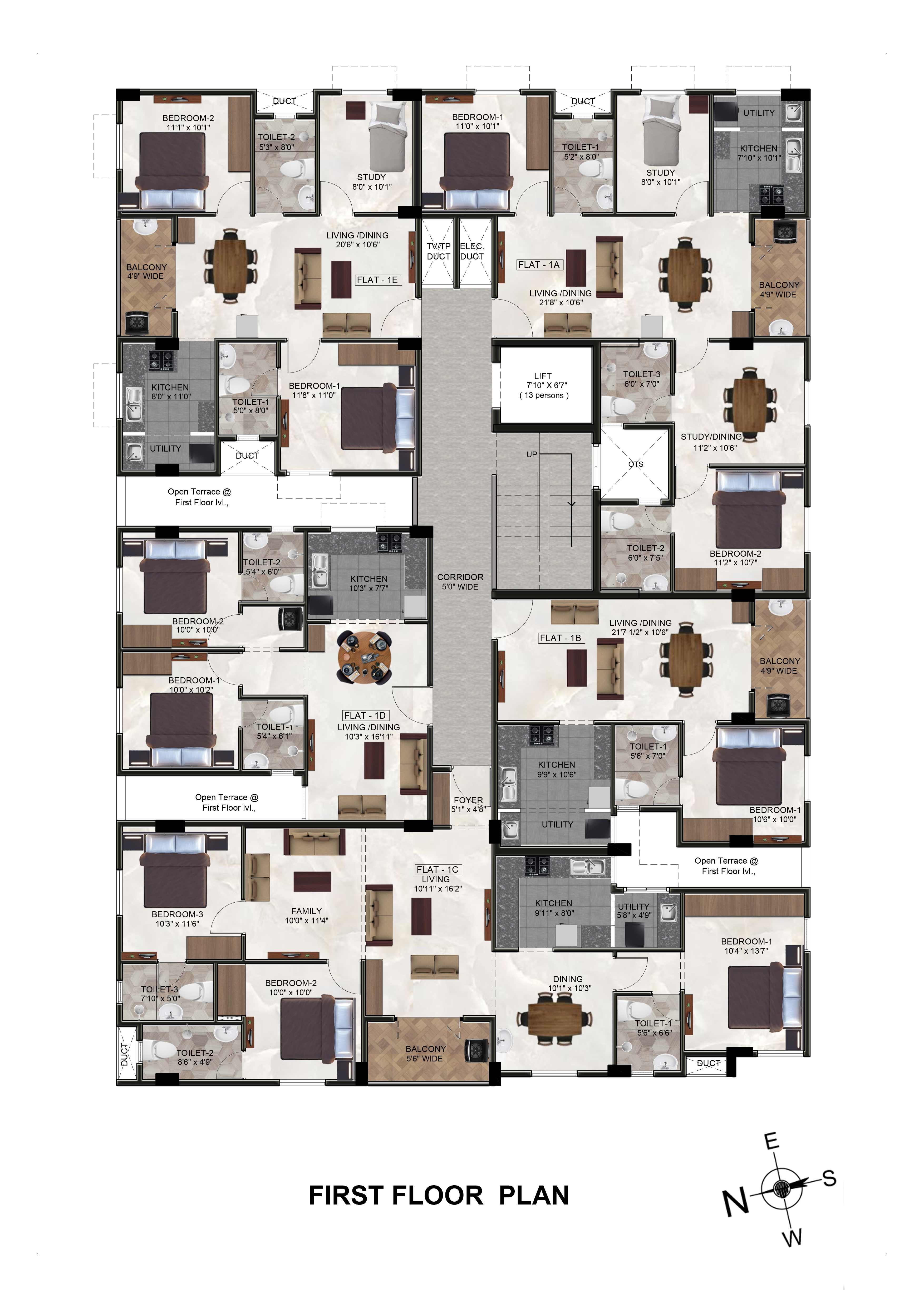

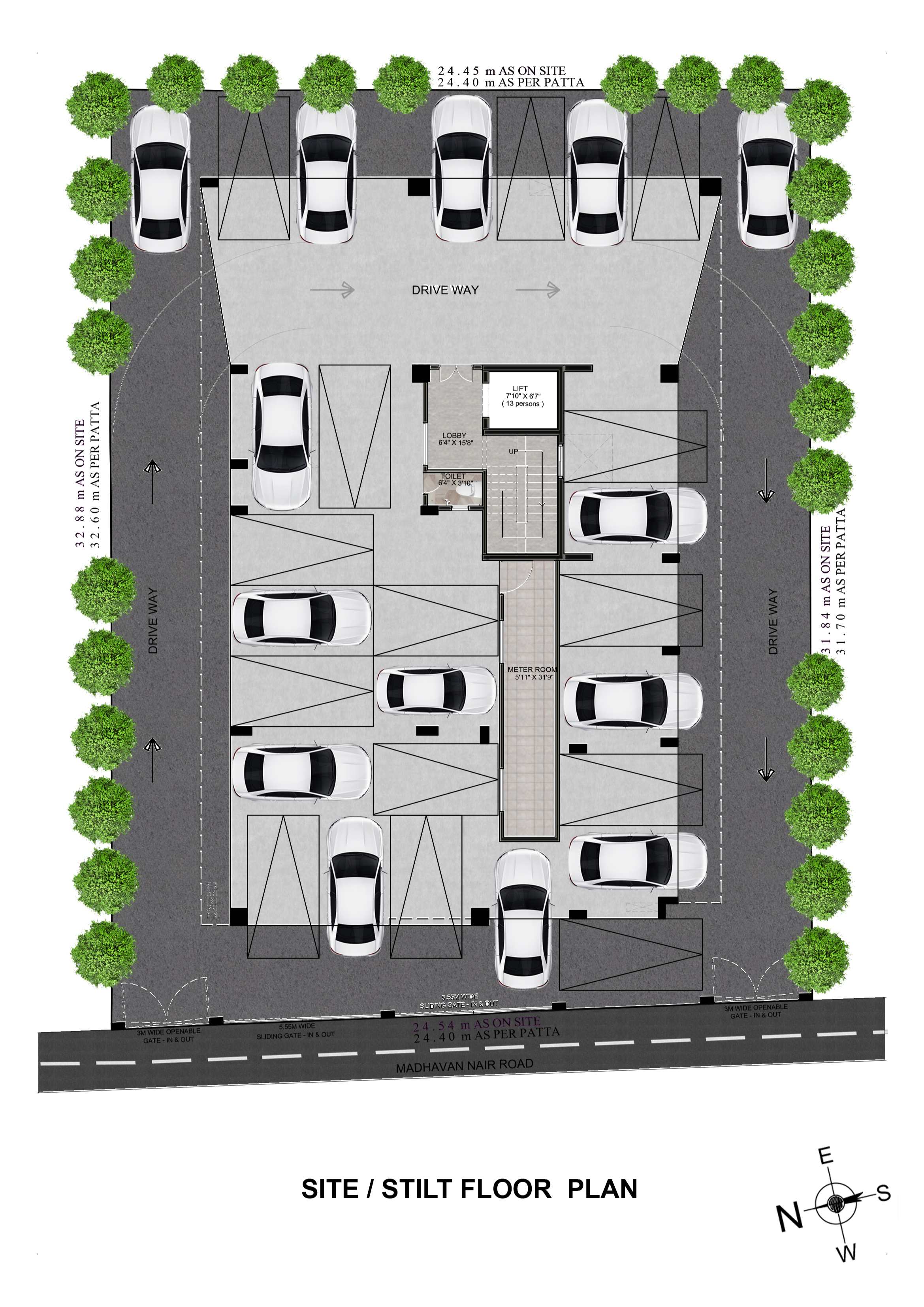

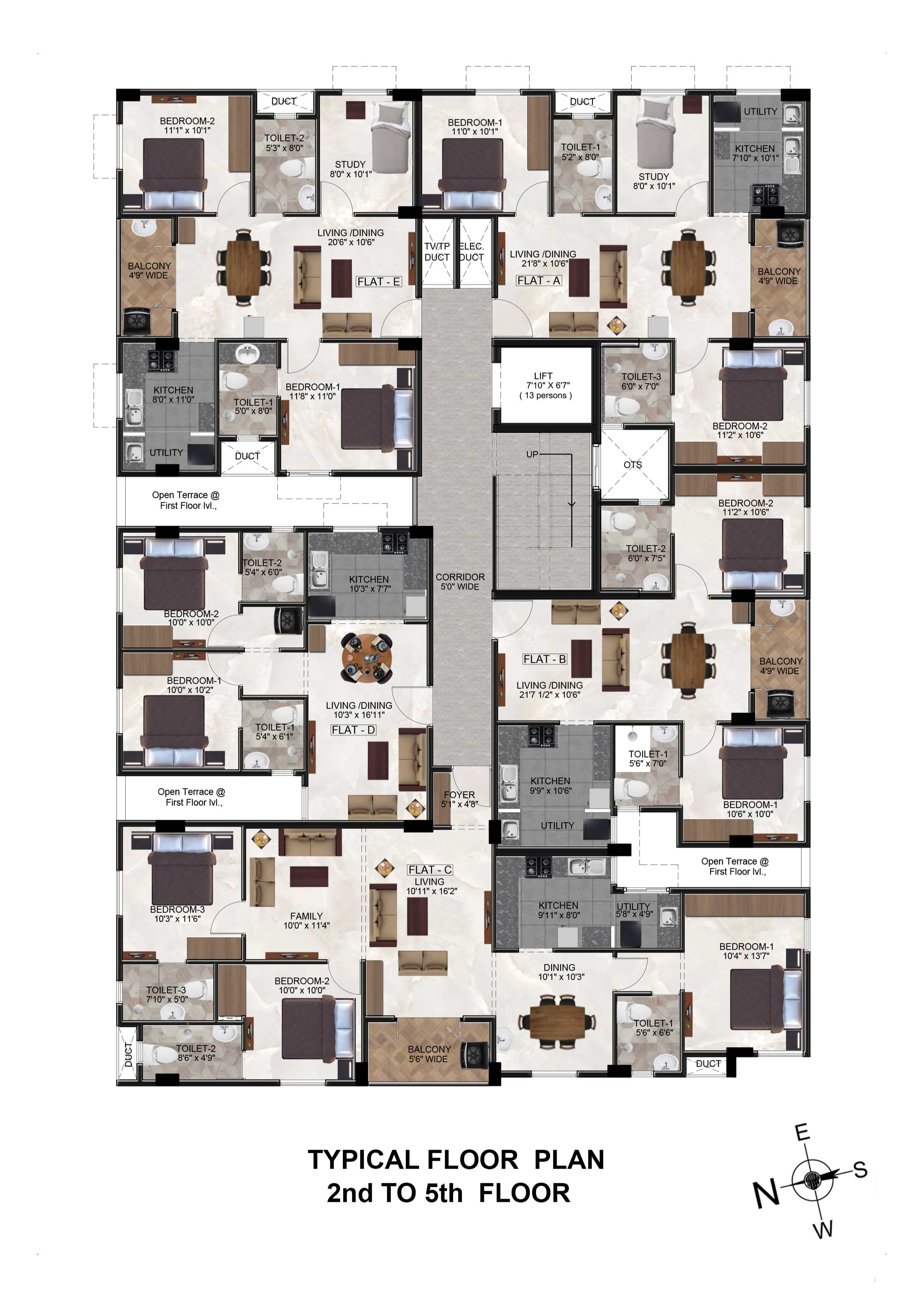

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
5D 5 2BHK + 2T 721 West Available

Approvals

Planning Permit No:

PP / NHRB / 364 / 2021

Date of Permit:

2021-12-28

Building Permission No:

CEBA / WDCN09 / 00004 / 2022

Date of Permit:

2022-01-03

TNRERA:

TN/29/Building/0059/2022

Dated:

2022-02-14

Project Update Images

  • 5th floor inner plastering work is 95% completed.
  • Upto 3rd floor toilet wall tile laying work is in progress.
  • Upto 3rd floor general flooring work is in progress.
  • Elevation tile fixing work is completed.
  • Staircase handrail fixing work is 80% completed.
  • UPVC window fixing work is 90% completed.
  • Terrace floor weathering course work is in progress.

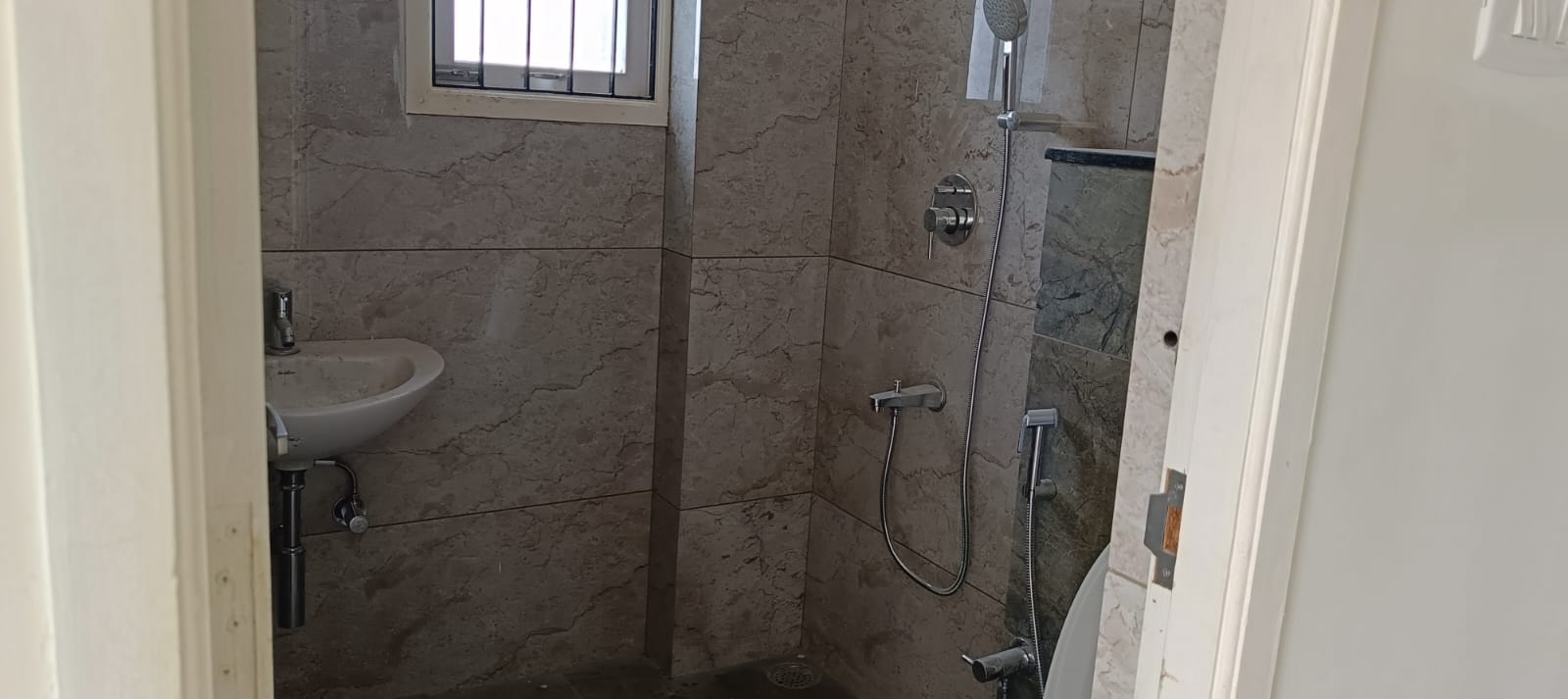

  • 4th floor toilet wall tile laying work is completed
  • 4th floor general flooring work is in progress. (60% completed)
  • Staircase handrail fixing work is 95% completed.
  • UPVC window fixing work is 95% completed.

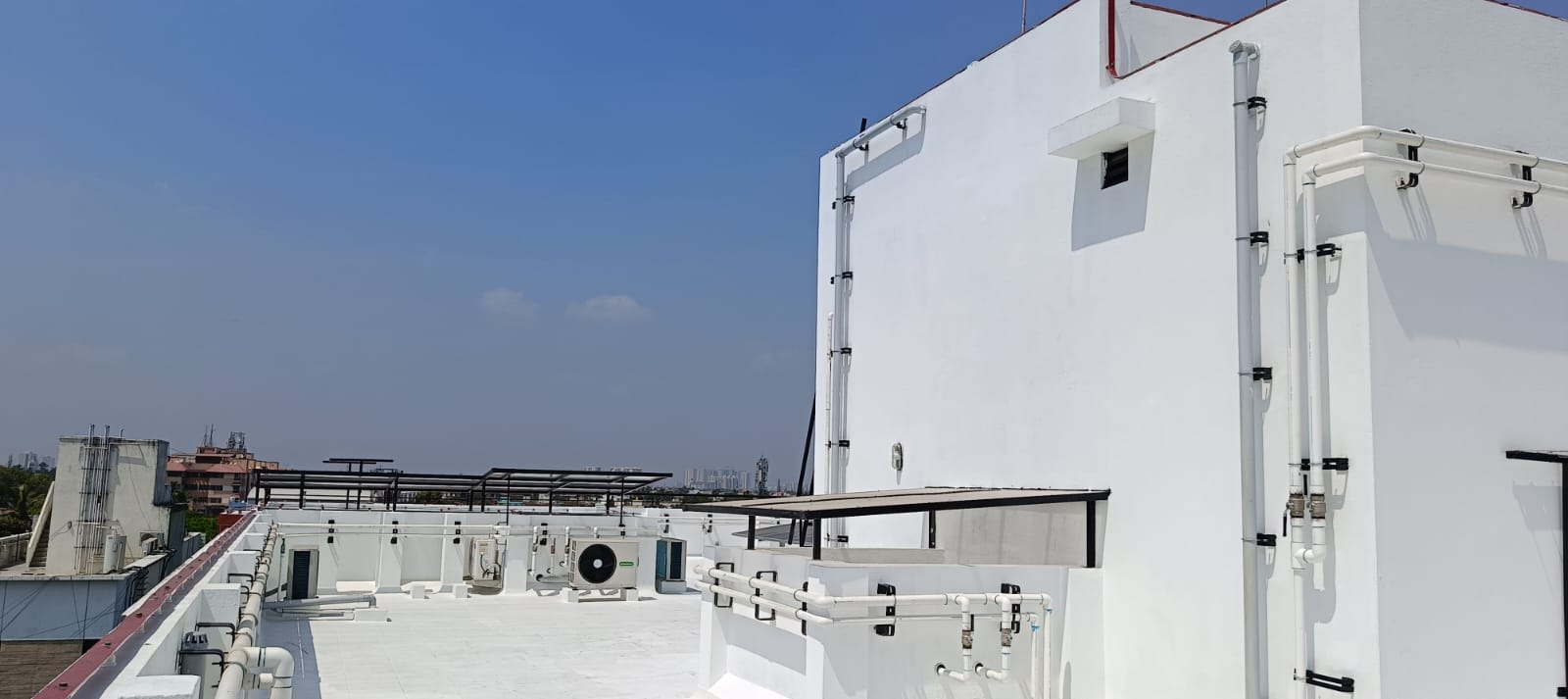

  • Terrace floor weathering course work is 90% completed.

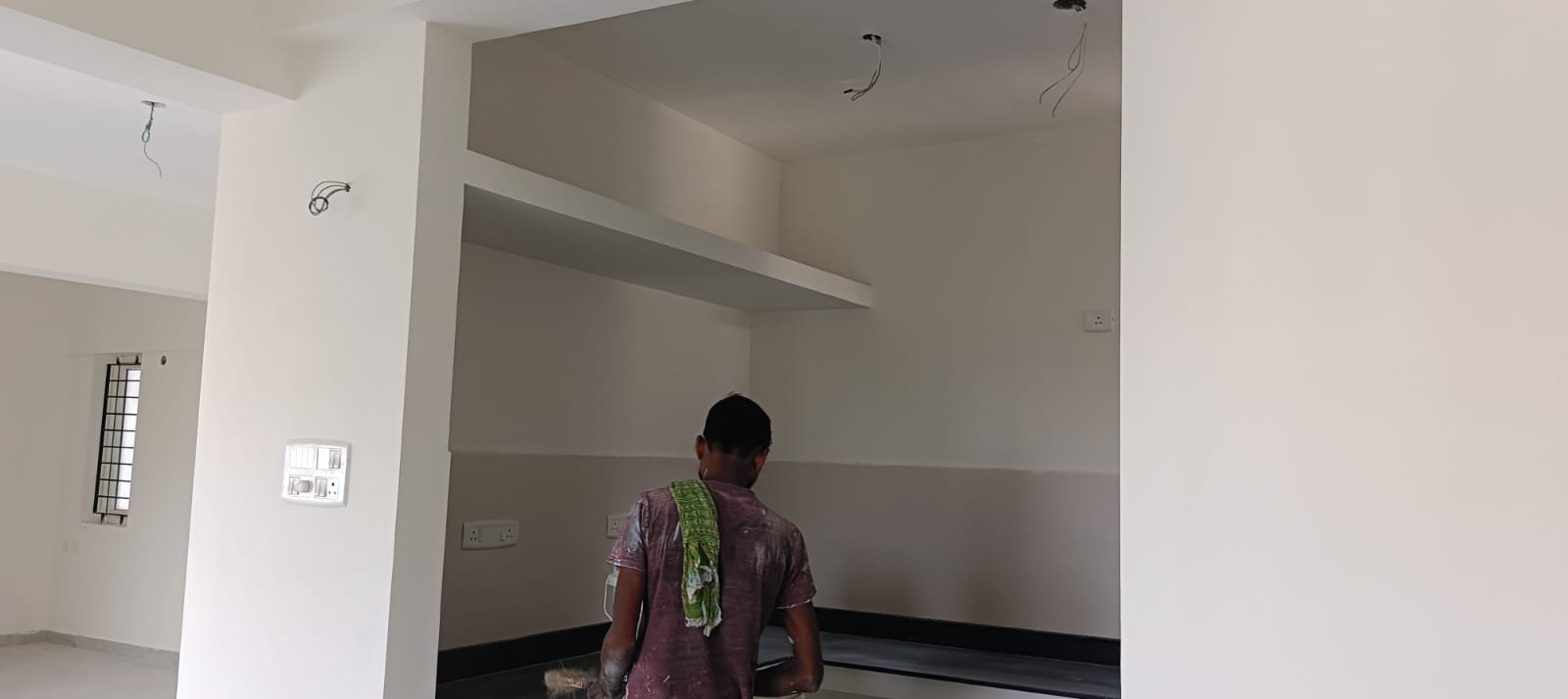

  • Upto 3rd floor inner wall primer coat painting work is in progress. (80% completed)
  • Lift erection work is in progress.
  • 4th floor toilet wall tile laying work is completed

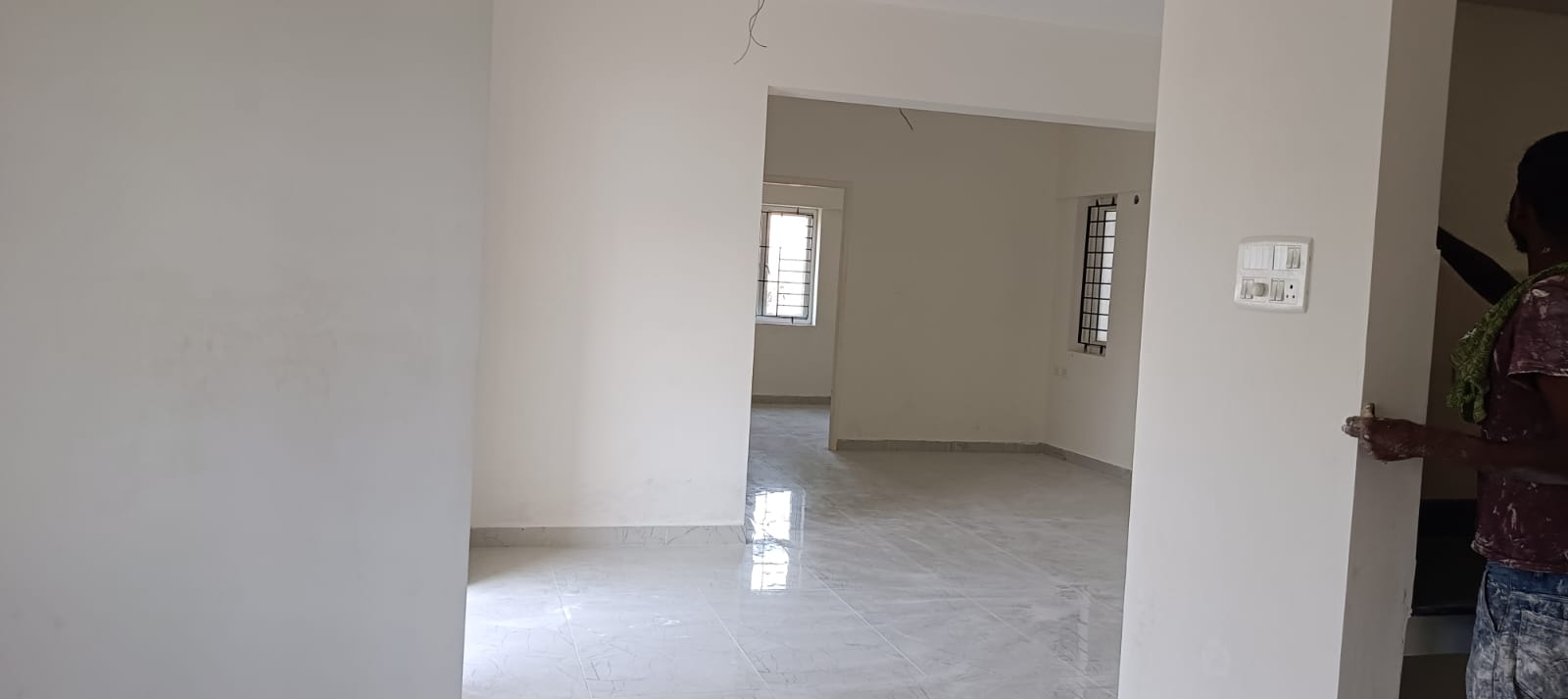

  • 4th floor general flooring work is completed
  • Staircase handrail fixing work is 95% completed.
  • UPVC window fixing work is 95% completed.

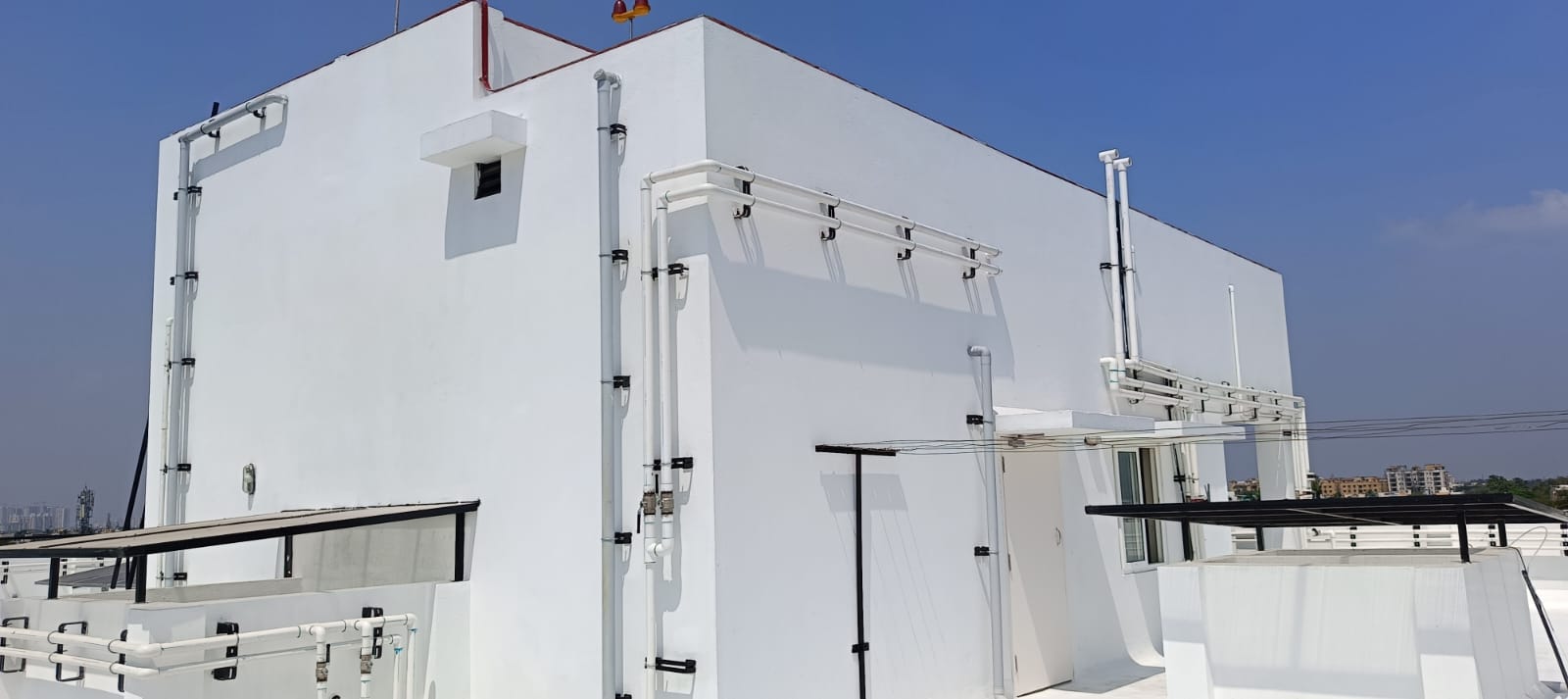

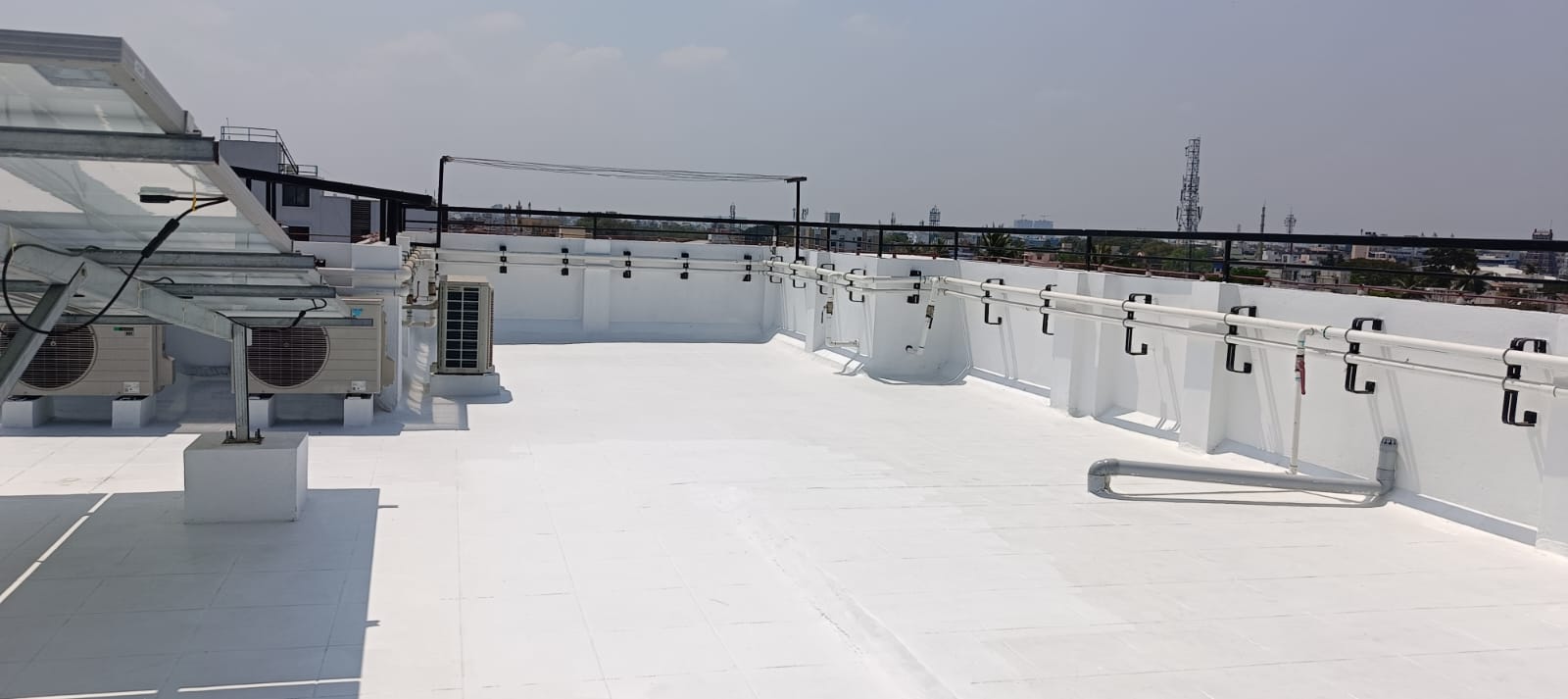

  • Terrace floor weathering course work is completed.
  • Upto 3rd floor inner wall primer coat painting work is in progress. (85% completed)
  • Lift erection work is in progress.
  • Outer Texture painting work is in progress.(60% completed)
  • 4th floor toilet wall tile laying work is completed
  • 4th floor general flooring work is completed
  • Staircase handrail fixing work is 95% completed.
  • UPVC window fixing work is 95% completed.
  • Terrace floor weathering course work is completed.
  • Upto 3rd floor inner wall primer coat painting work is in progress. (85% completed)
  • 5th floor toilet wall tile laying work is in progress (25% completed)
  • 5th floor general flooring work is in progress. (25% completed)
  • Upto 3rd floor inner wall primer coat painting work is in progress. (85% completed)
  • Lift erection work is in progress. (50% completed)
  • All floor lift wall cladding work is in progress (90% completed)

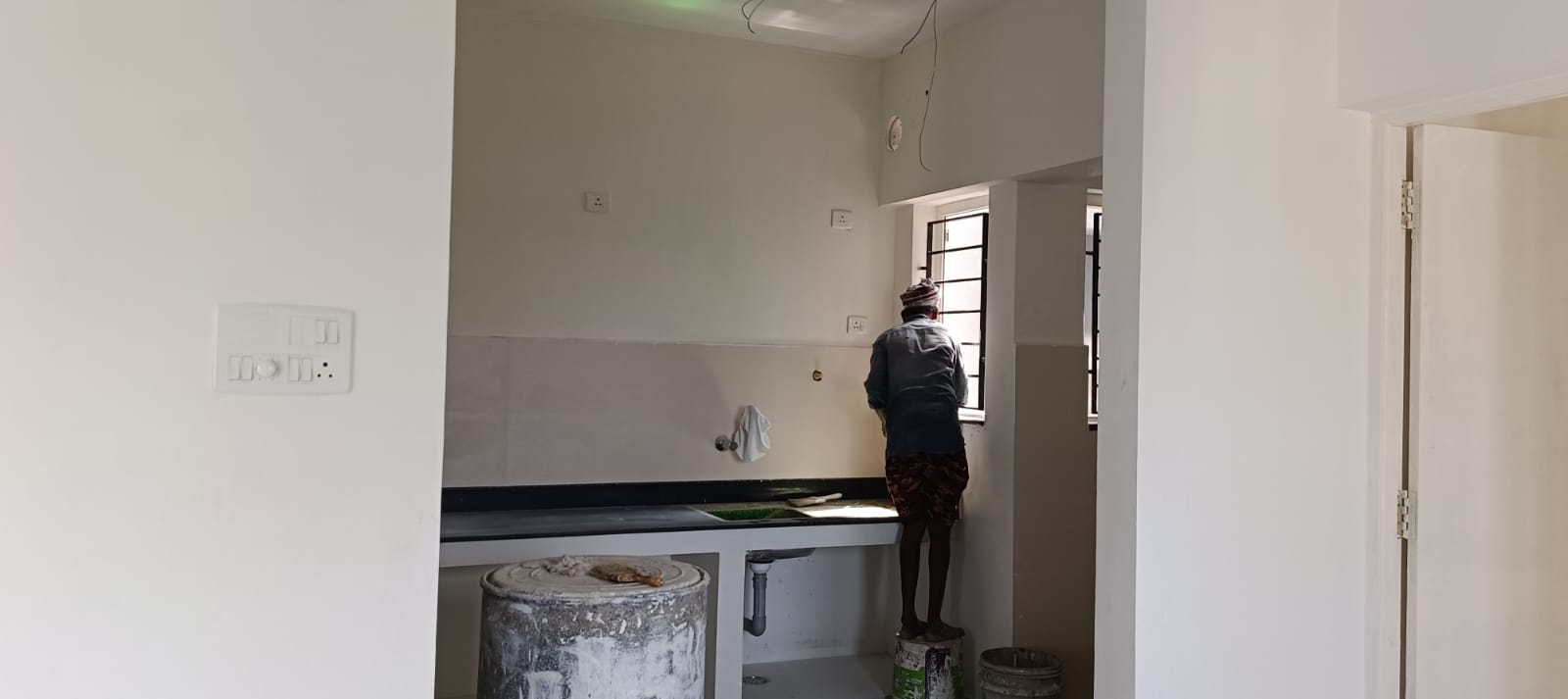

  • Wood work is in progress (Flat 3A, 3B & 3E).
  • Outer Texture painting work is completed.
  • External duct plumbing work is in progress.
  • External chamber work is in progress (60% completed).
