Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 sales@ramaniyam.com

Rathnagiri

Besant Nagar

Enquire Now

Amenities

Elevators
24/7 Power Backup
Rain Water Harvesting

Master Layout Plan

Approvals

Planning Permit No:

C / PP / MSB /13 (A to B) / 2021

Date of Permit:

2021-03-19

Building Permission No:

CEBA / WDCN13 / 00103 / 2021

Date of Permit:

32021-03-21

TNRERA:

TN / 29 / Building / 0096 / 2022

Dated:

2022-03-31

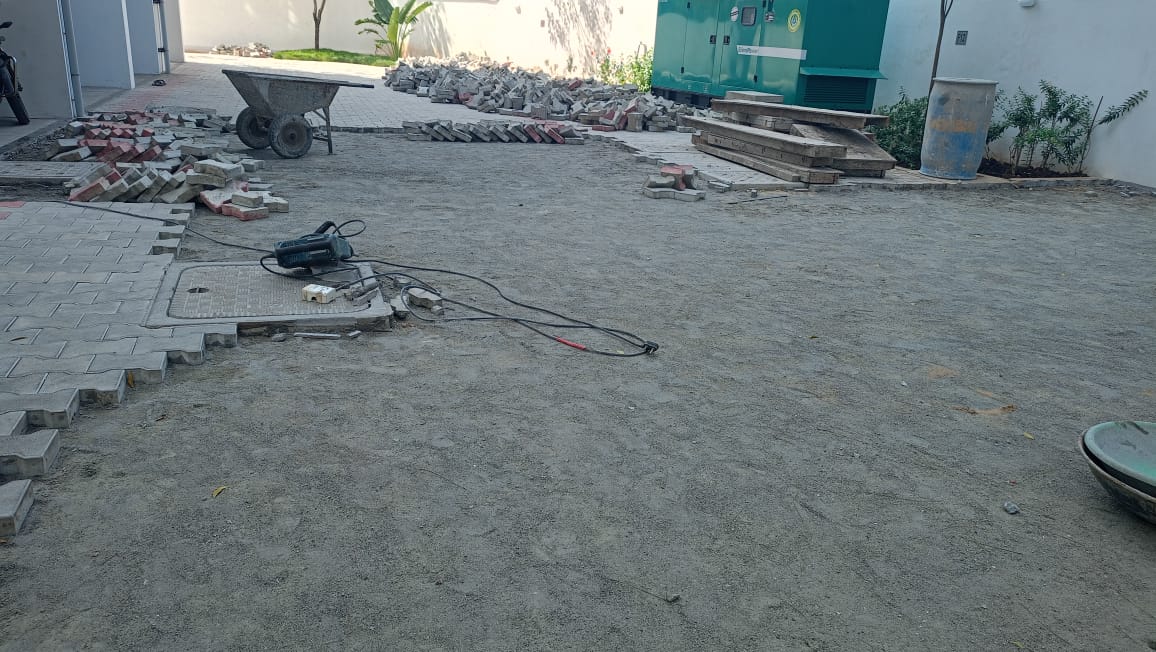

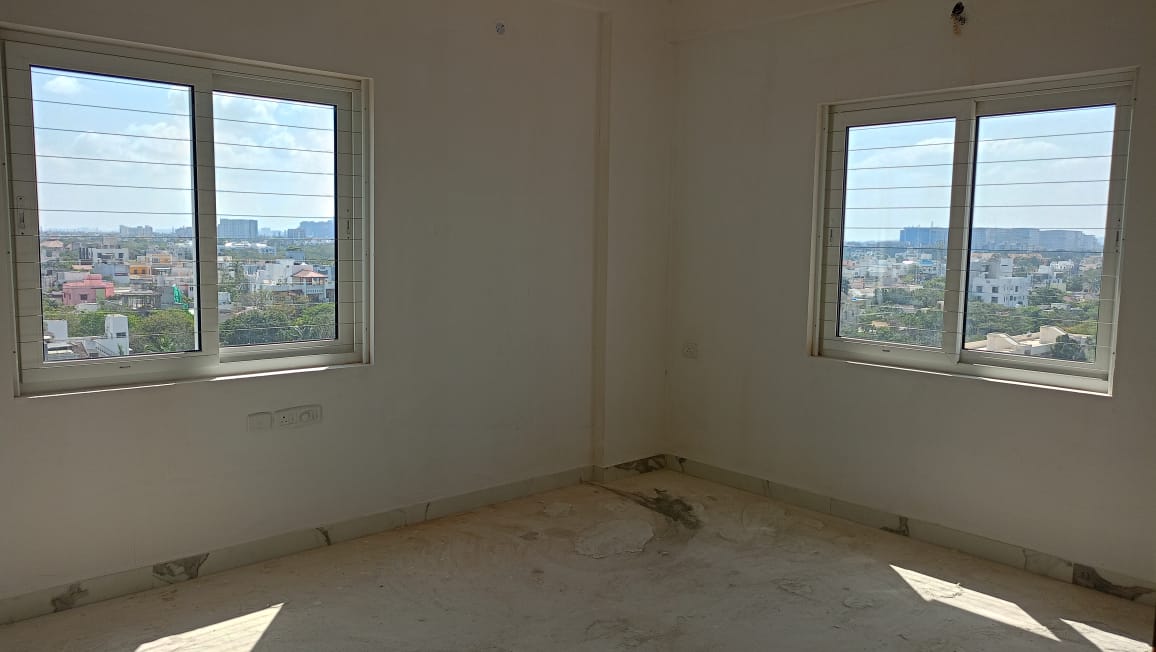

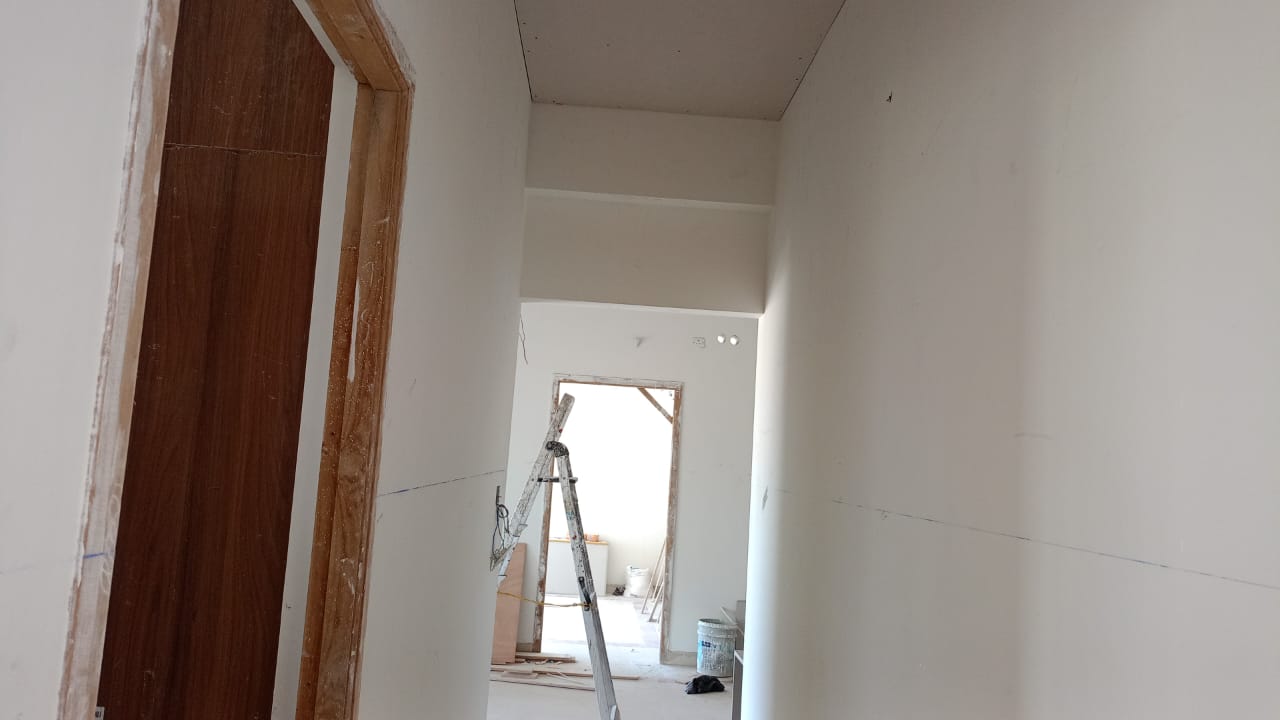

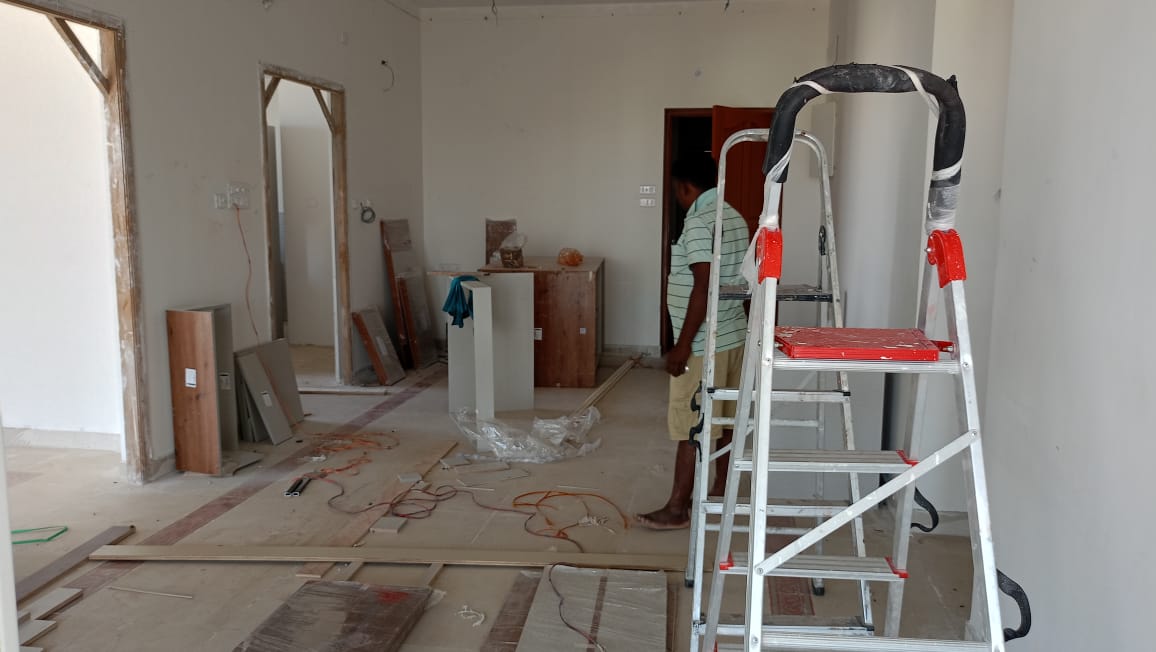

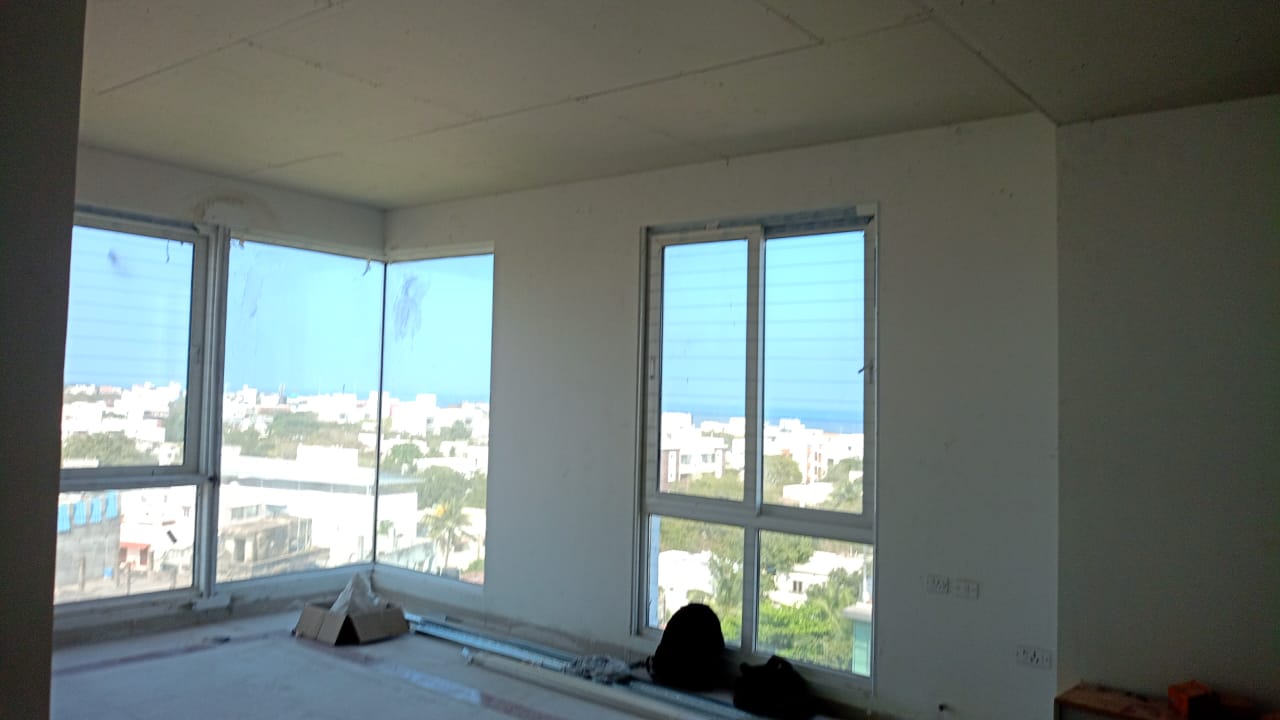

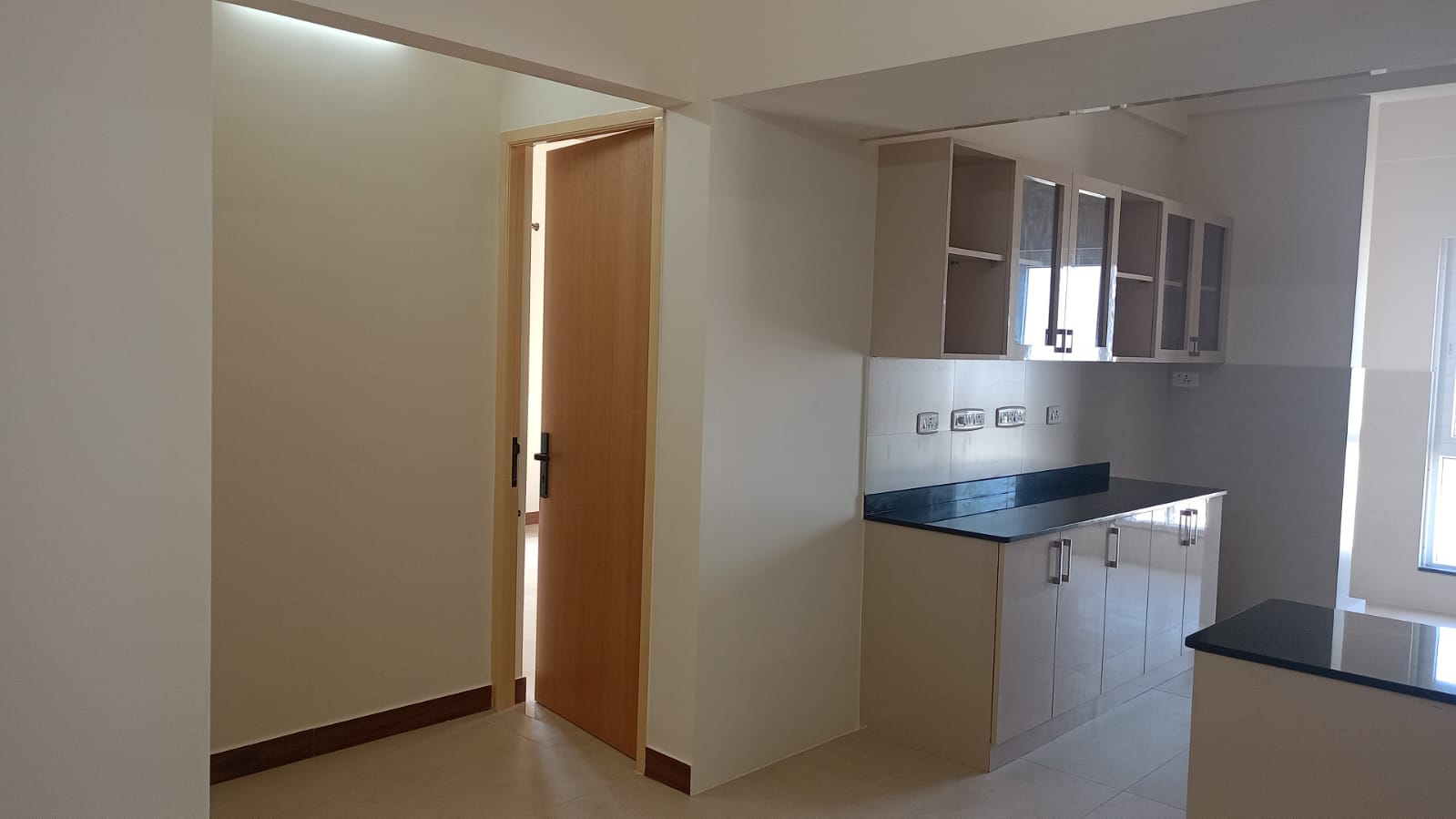

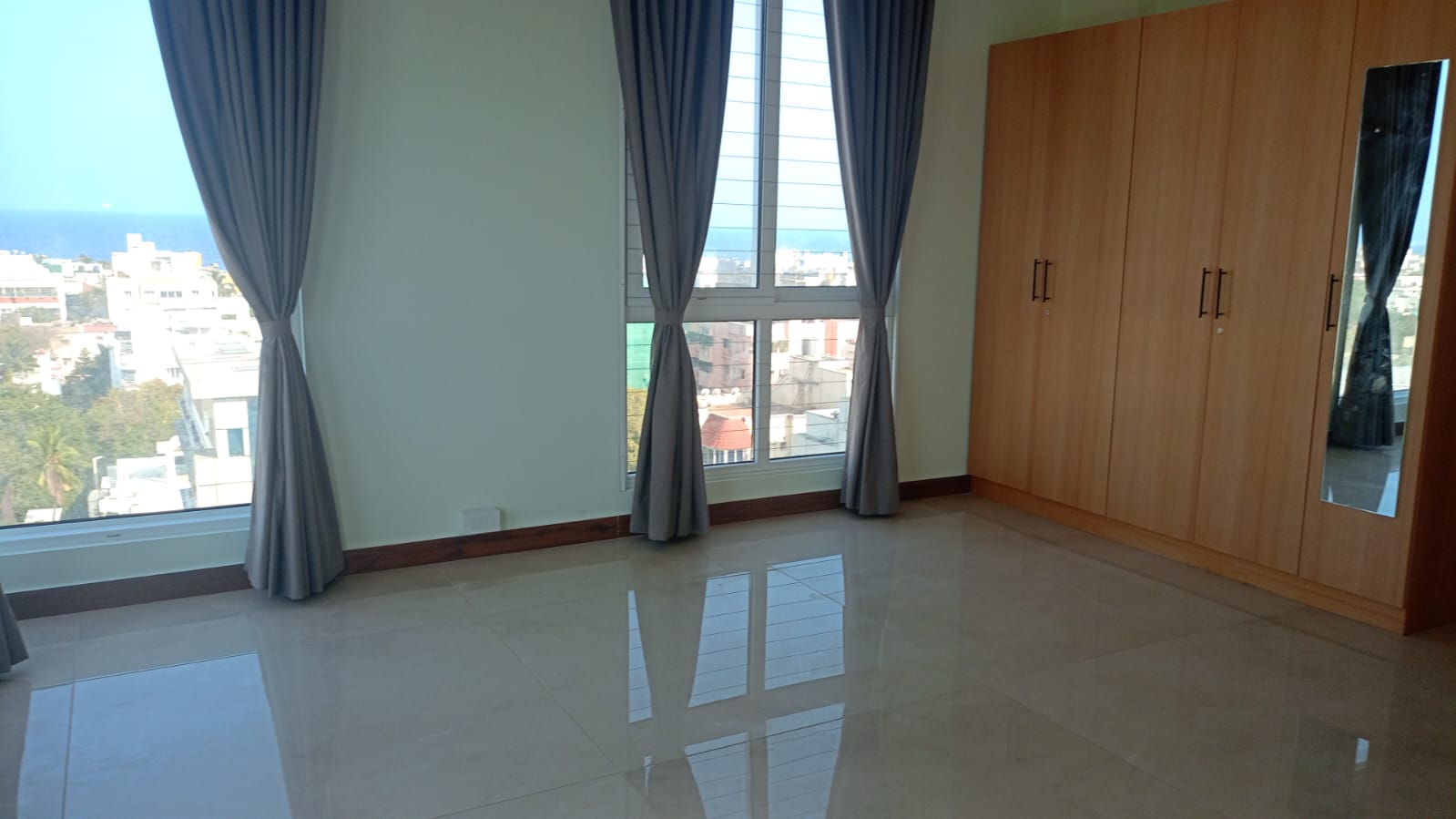

Project Update Images

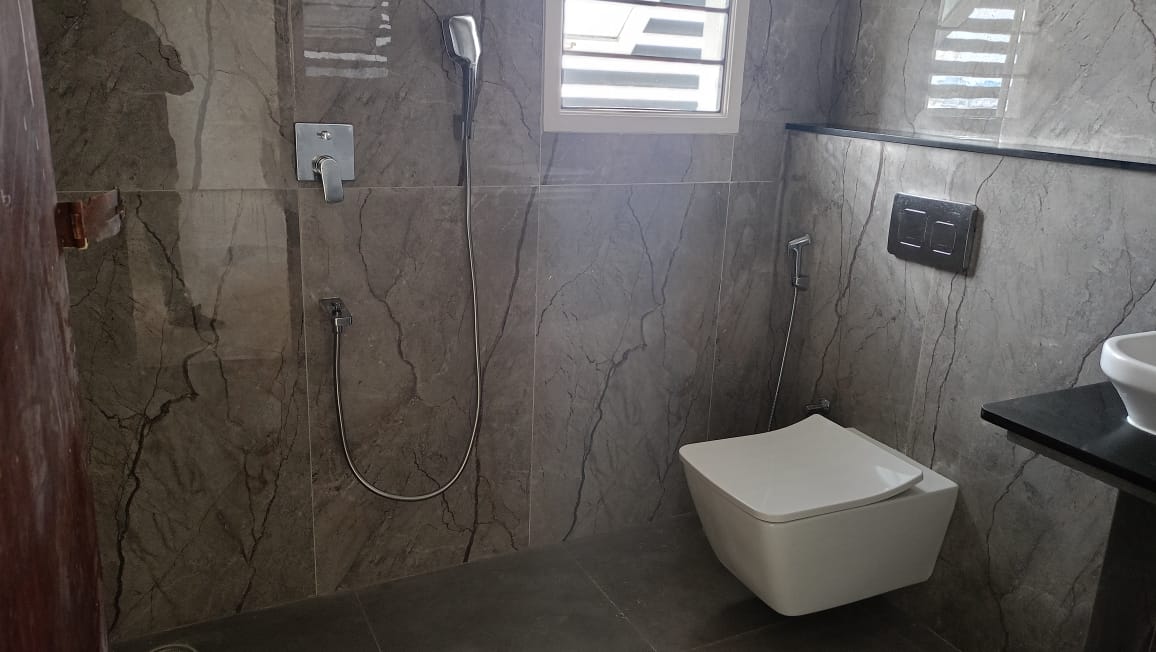

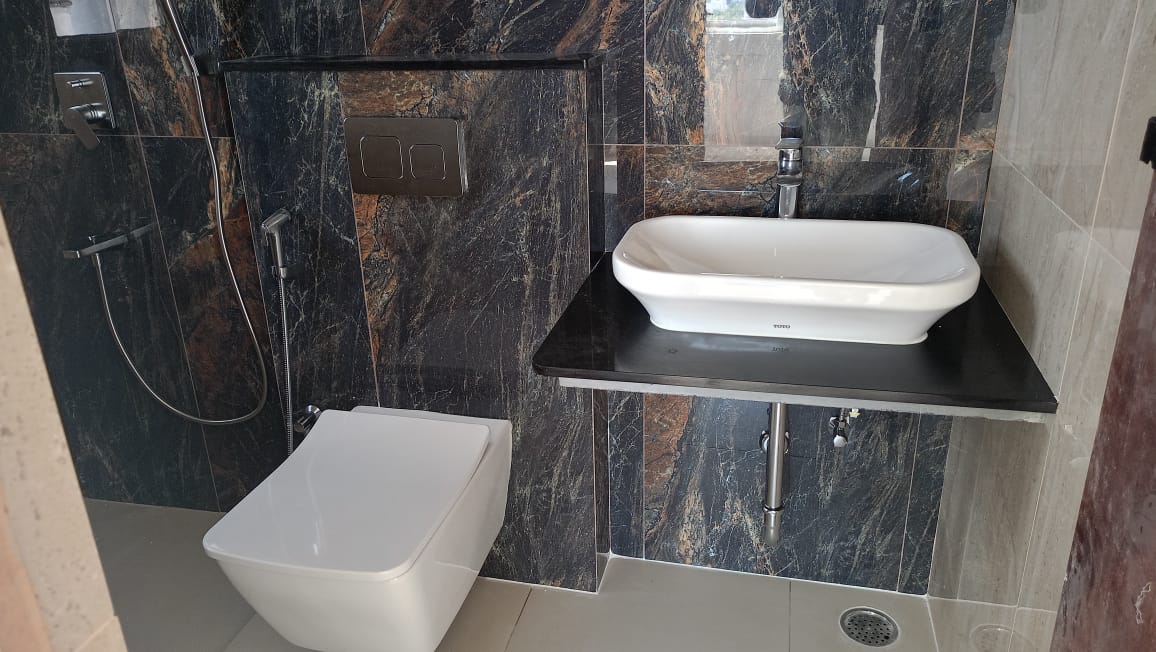

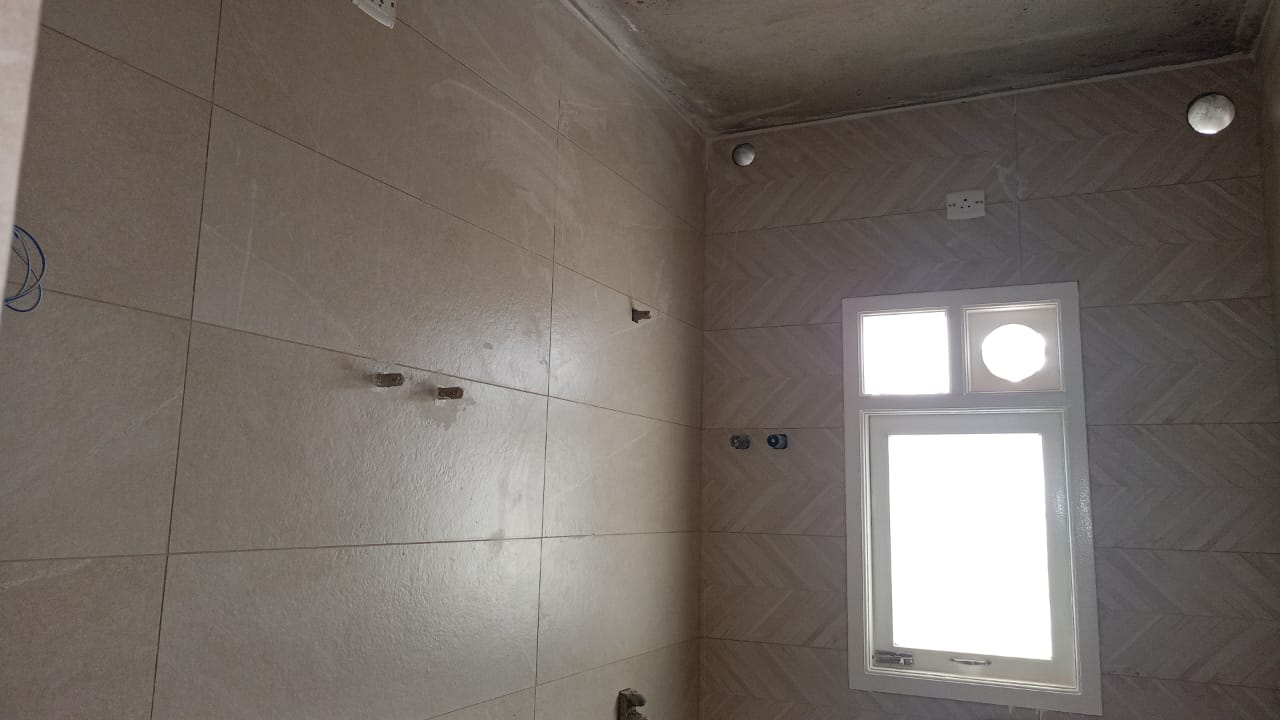

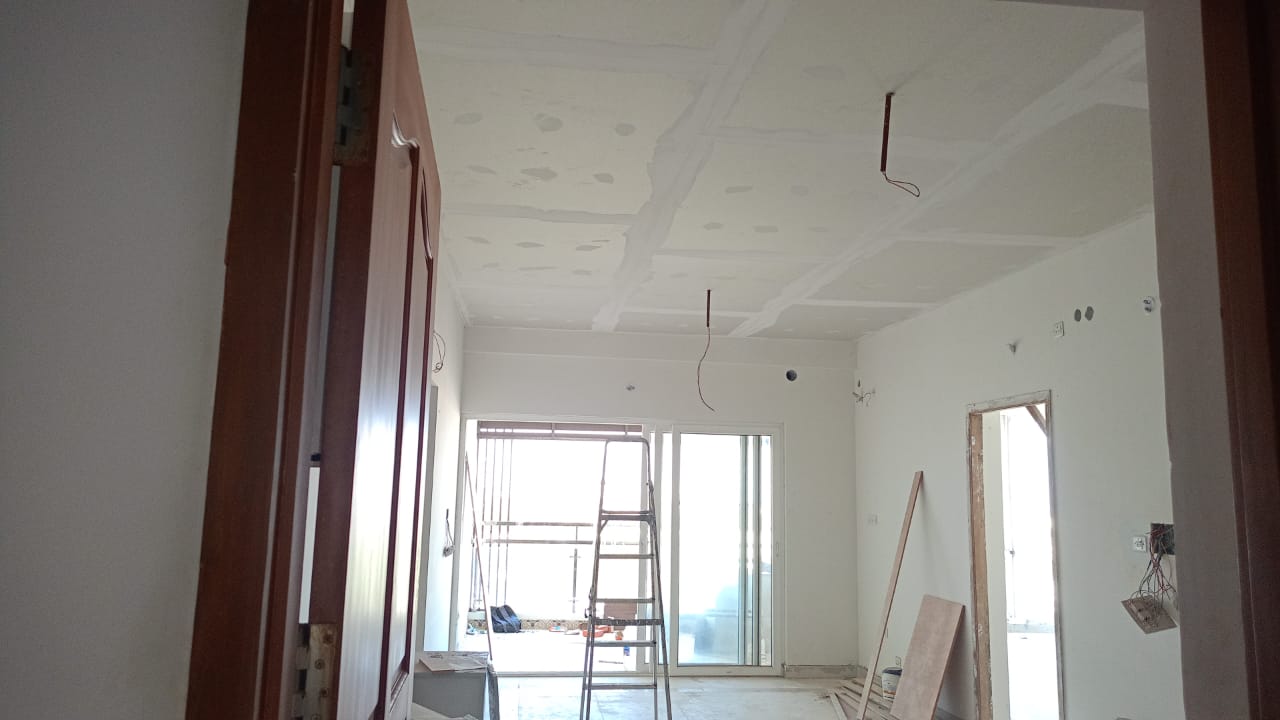

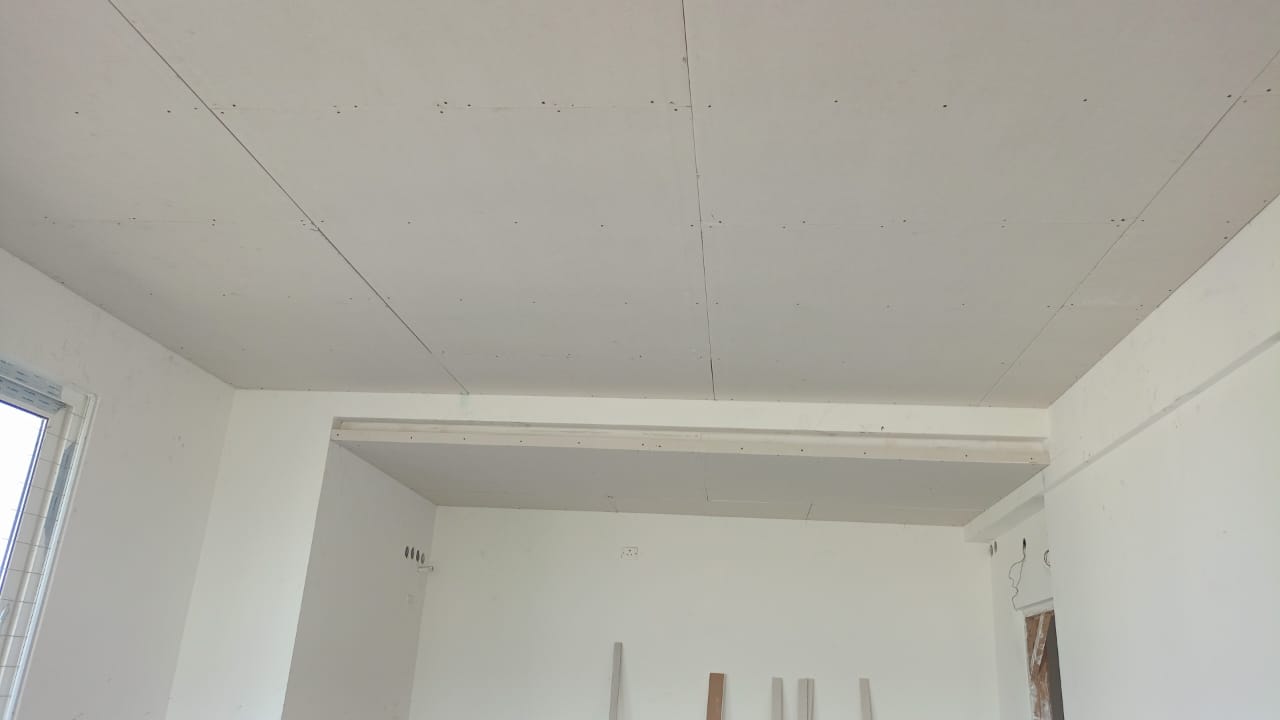

  • 7th and 8th floor toilet tile laying work is in progress. (50% completed)
  • 7th floor general flooring work is in progress.(50% completed)
  • All floor Staircase & Lobby flooring work is in progress. (70% completed)
  • Lift erection work is 50% completed.

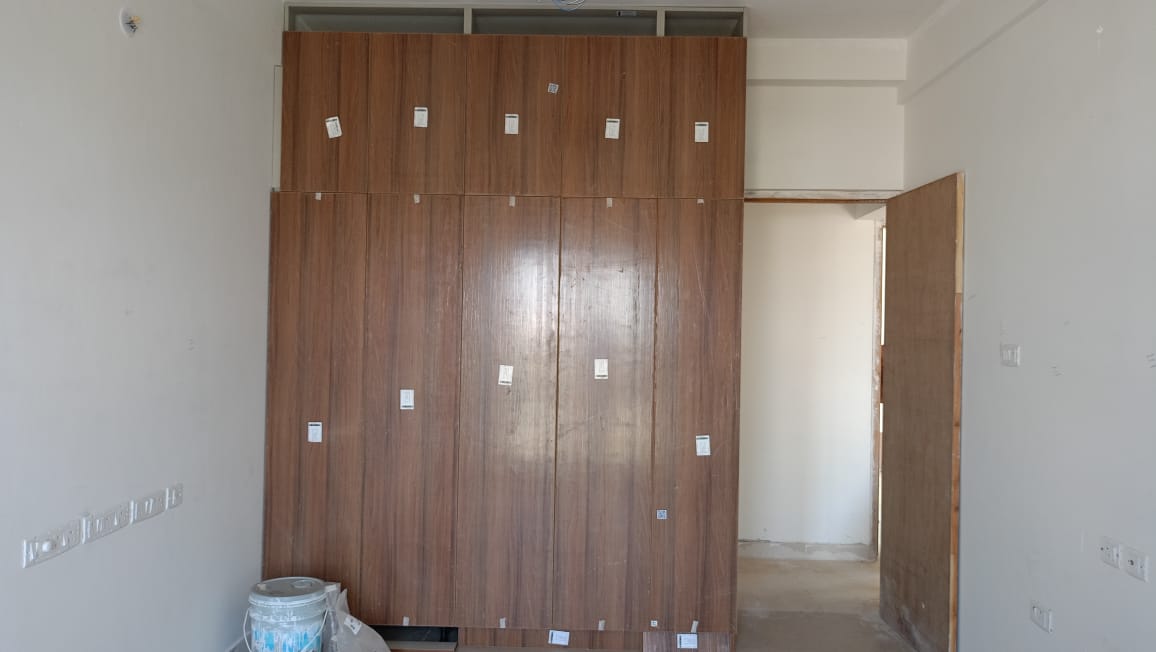

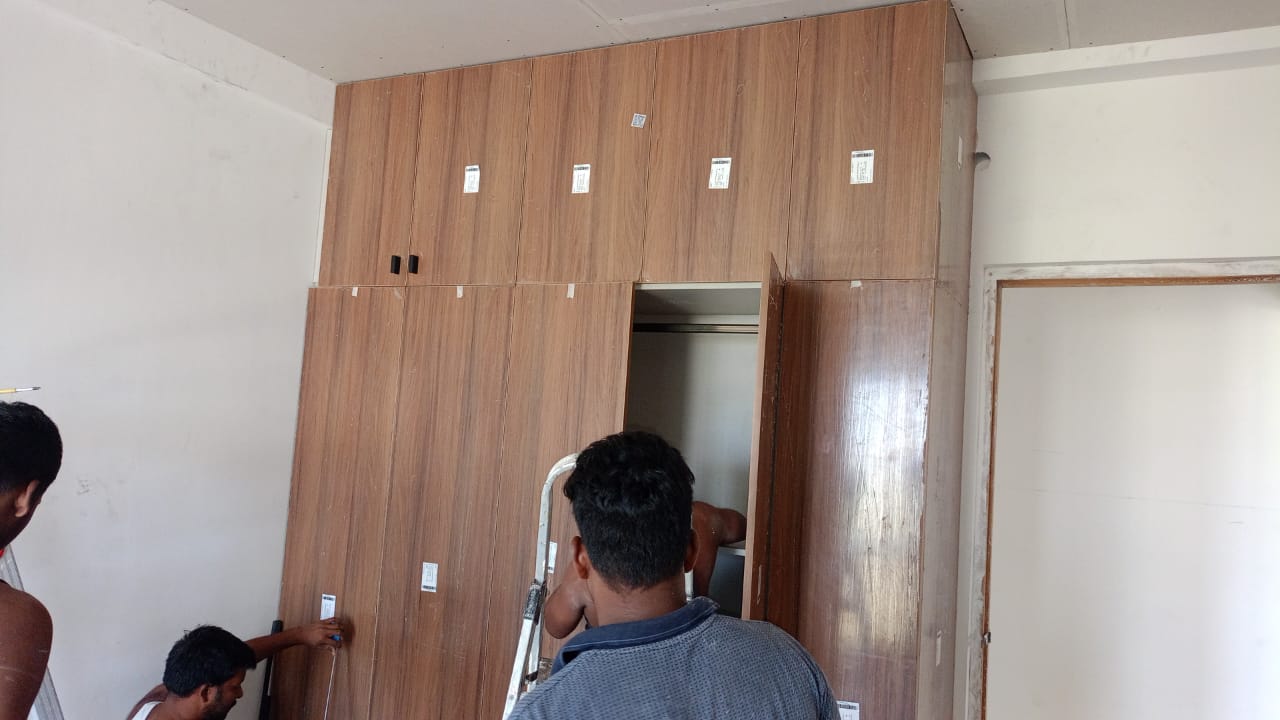

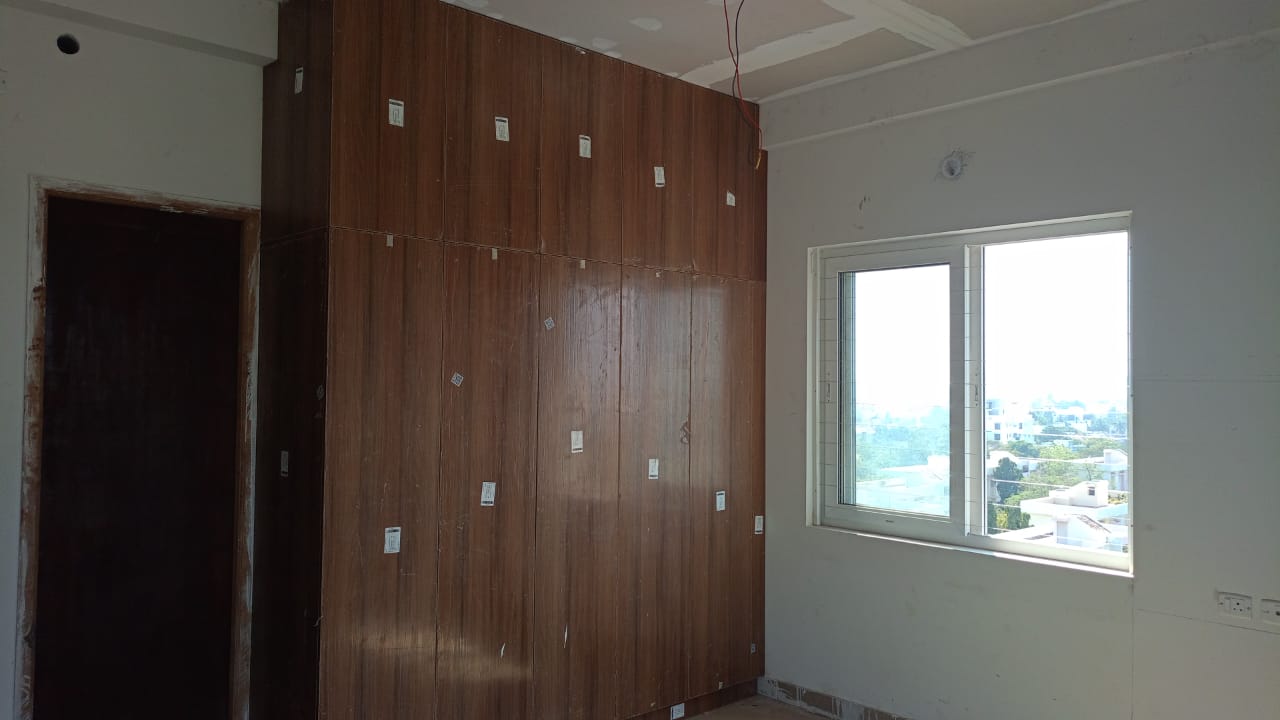

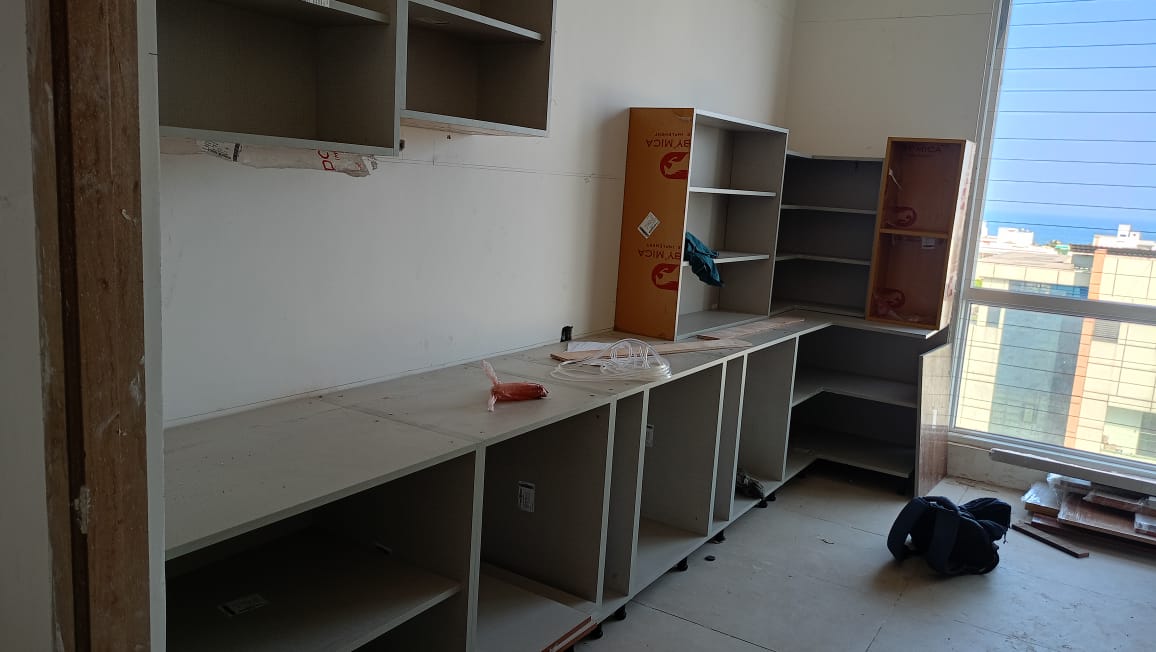

  • Upto 6th floor Modular kitchen wood work is in progress

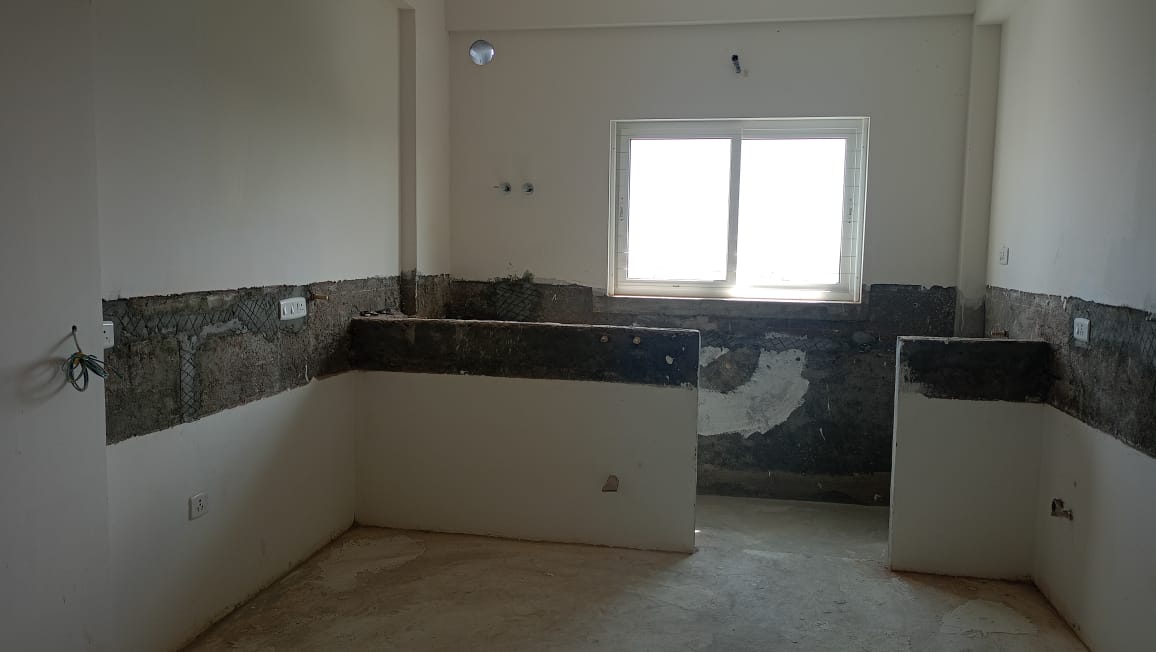

  • Upto 6th floor electrical wiring and Switches fixing work is completed.
  • Duct covering work is in progress. (50% completed)

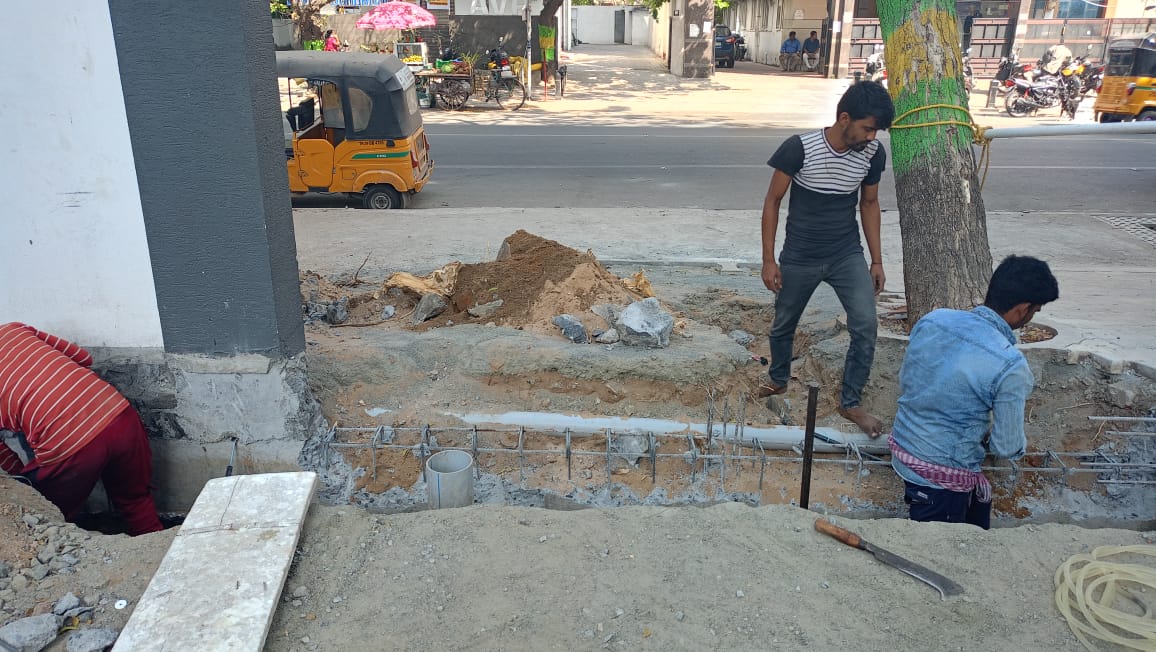

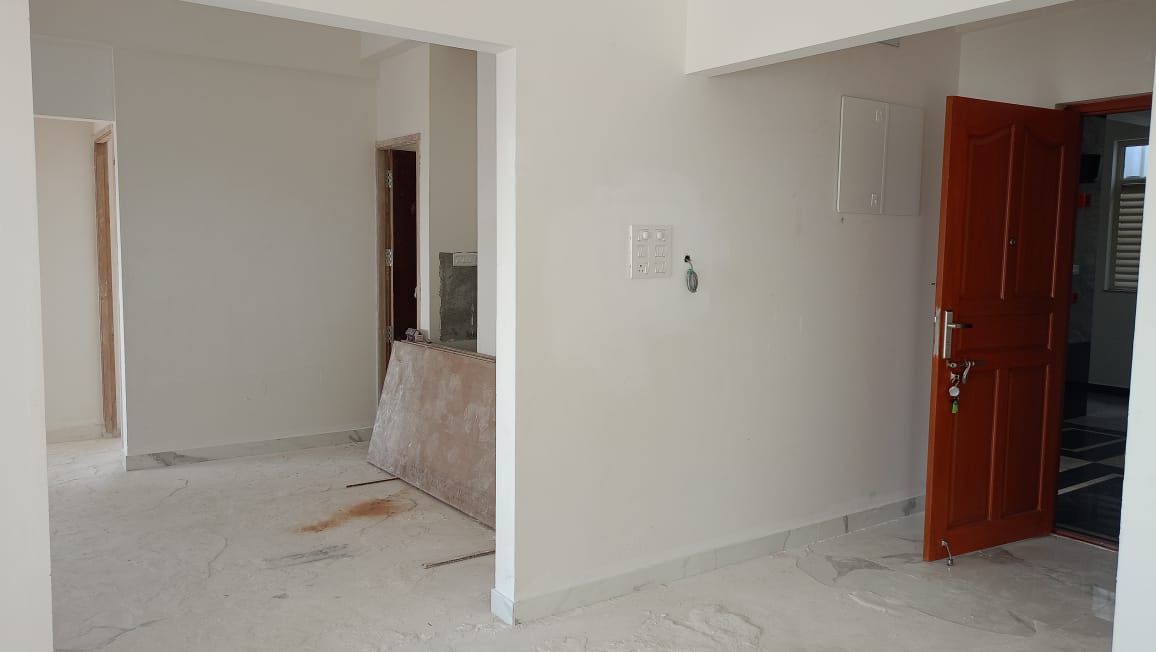

  • Compound wall work is in progress (West side 50% completed)
  • 7th and 8th floor toilet tile laying work is in progress. (50% completed)
  • 7th floor general flooring work is in progress.(50% completed)
  • All floor Staircase & Lobby flooring work is completed
  • Lift erection work is 50% completed.
  • Upto 6th floor Modular kitchen wood work is in progress
  • Upto 6th floor electrical wiring and Switches fixing work is completed.
  • Duct covering work is in progress. (80% completed)
  • Compound wall work is in progress (West side 50% completed
  • 7th and 8th floor toilet tile laying work is in progress. (50% completed)
  • 7th and 8th floor general flooring work is in progress.(50% completed)
  • Lift erection work is 60% completed.
  • Upto 6th floor Modular kitchen wood work is in progress
  • Upto 6th floor electrical wiring and Switches fixing work is completed.
  • Duct covering work is completed.
  • Compound wall work is in progress (50% completed)
  • 7th and 8th floor toilet tile laying work is in progress. (50% completed)
  • 7th and 8th floor general flooring work is in progress.(50% completed)
  • Lift erection work is 60% completed.
  • Upto 6th floor Modular kitchen wood work is in progress
  • Upto 6th floor electrical wiring and Switches fixing work is completed.
  • Duct covering work is completed.
  • 7th and 8th floor toilet tile laying work is in progress. (50% completed)
  • 7th and 8th floor general flooring work is in progress.(50% completed)
  • Lift erection work is in progress.(1/2 completed)
  • Upto 6th floor Modular kitchen wood work is completed.
  • Compound wall work is in progress (70% completed)
