Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Purna Krishna

K.K.Nagar

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV
Elevators
Lobby

Rain Water Harvesting

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
2B 2 2BHK + 2T 1263 East Available
2C 2 3BHK + 3T 1693 South Available
3C 3 3BHK + 3T 1693 South Available
4C 4 3BHK + 3T 1693 South Available

Approvals

Planning Permit No:

OL - PP / NHRD / 0514 / 2024, Permit No. OL – 01149

Date of Permit:

2024-08-28

Building Permission No:

CEBA / WDCN10 / 00442 / 2024

Date of Permit:

2024-09-05

TNRERA:

TN / 29 / Building / 0572 / 2024

Dated:

2024-12-10

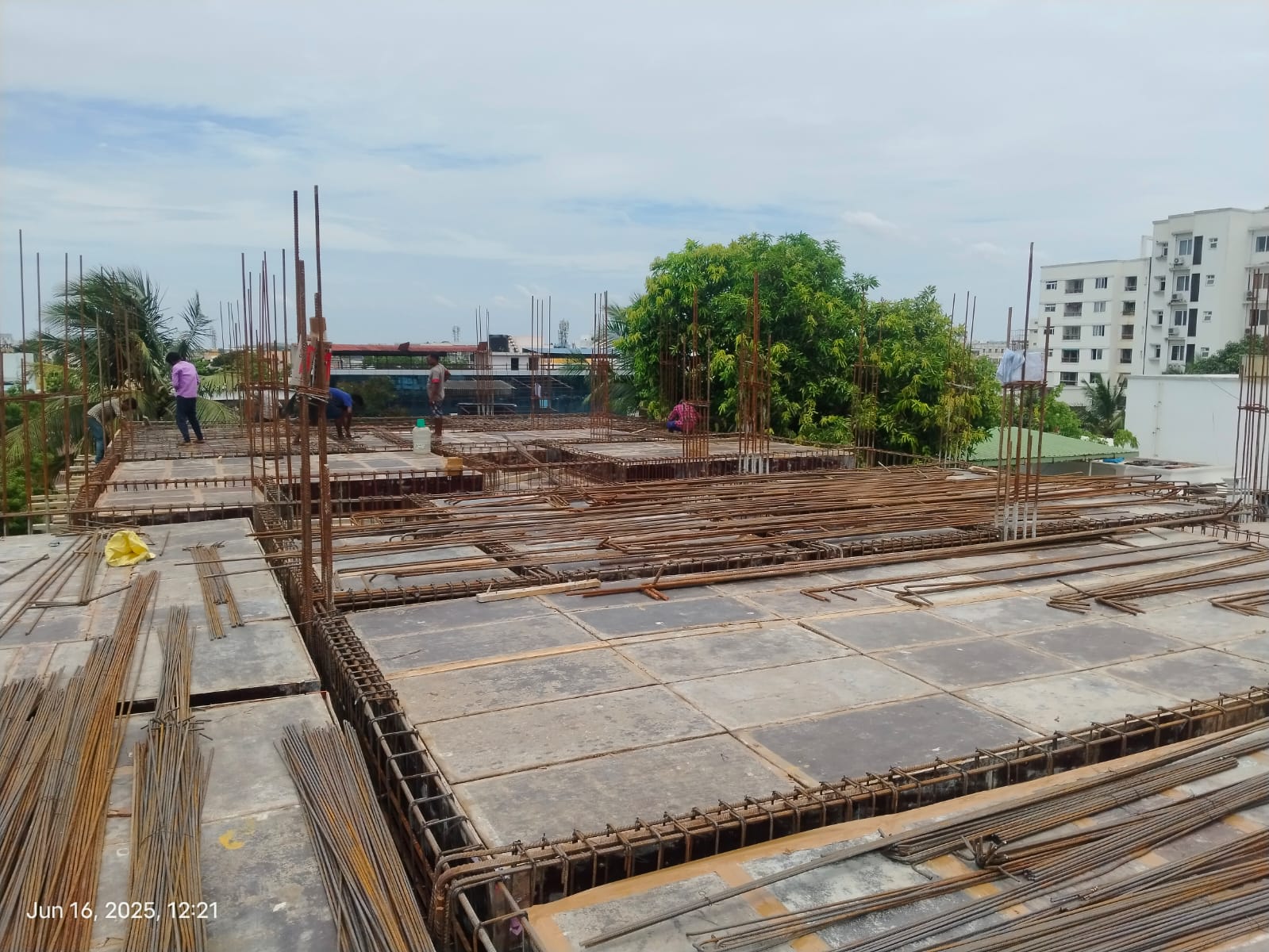

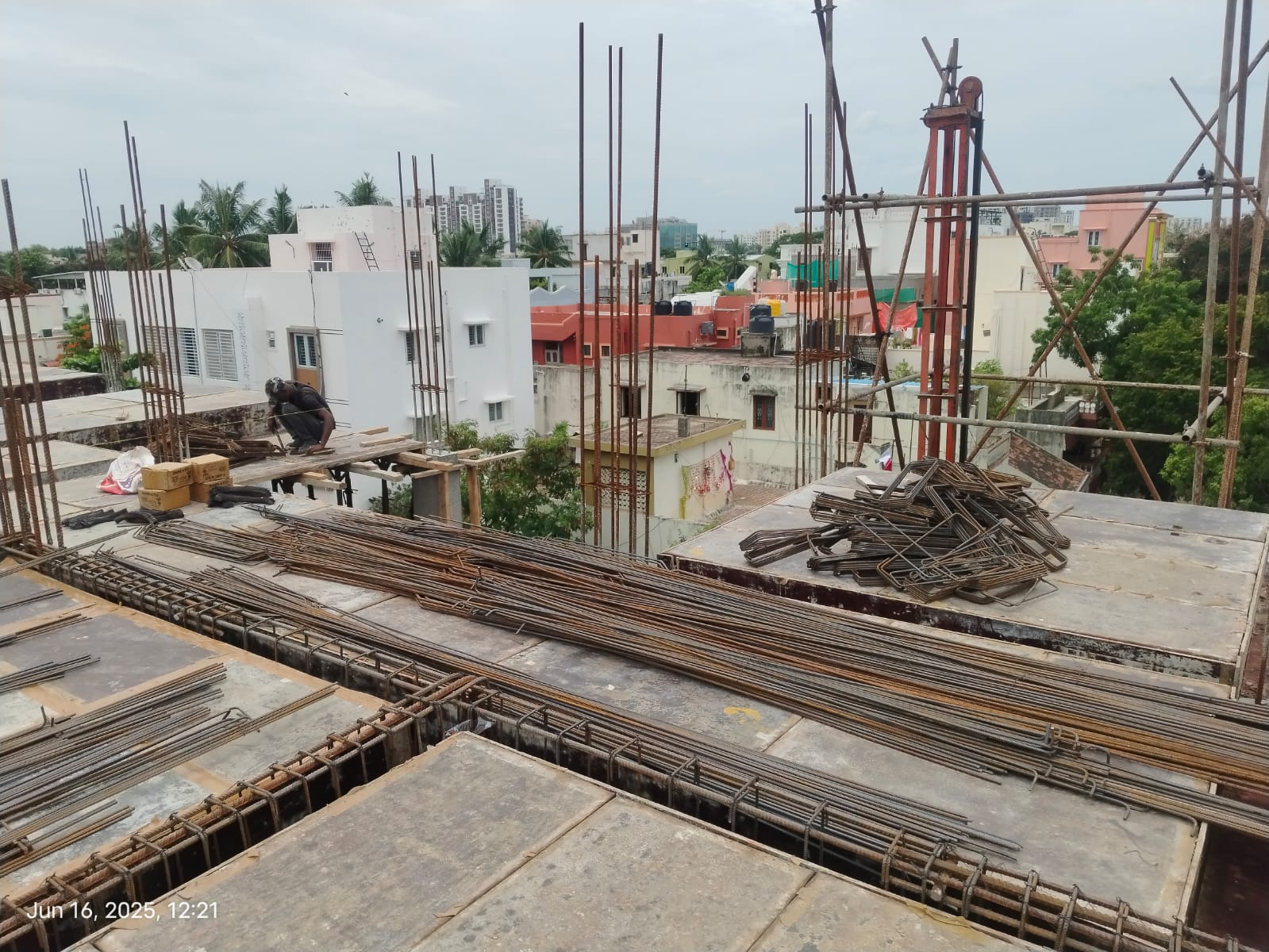

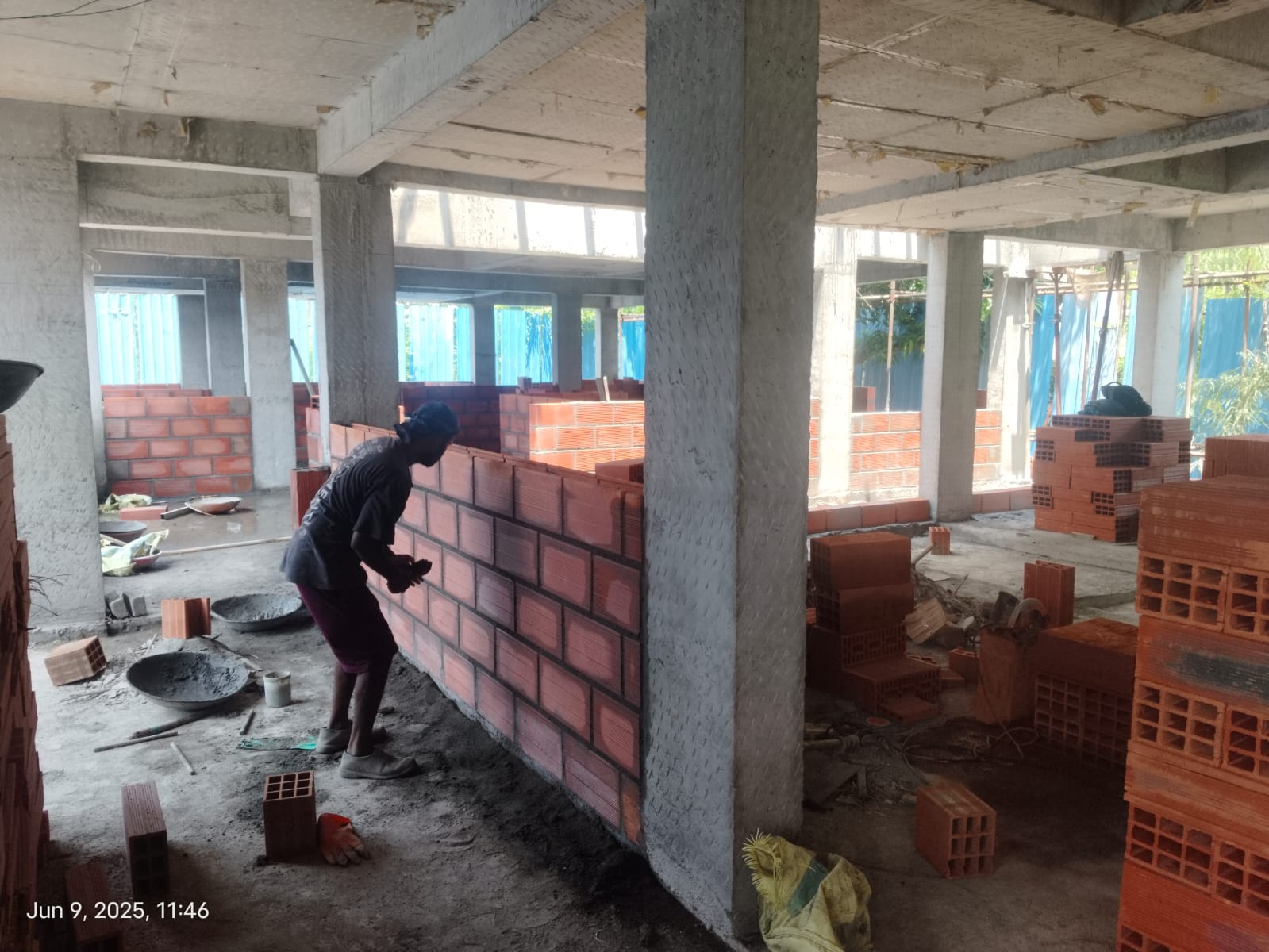

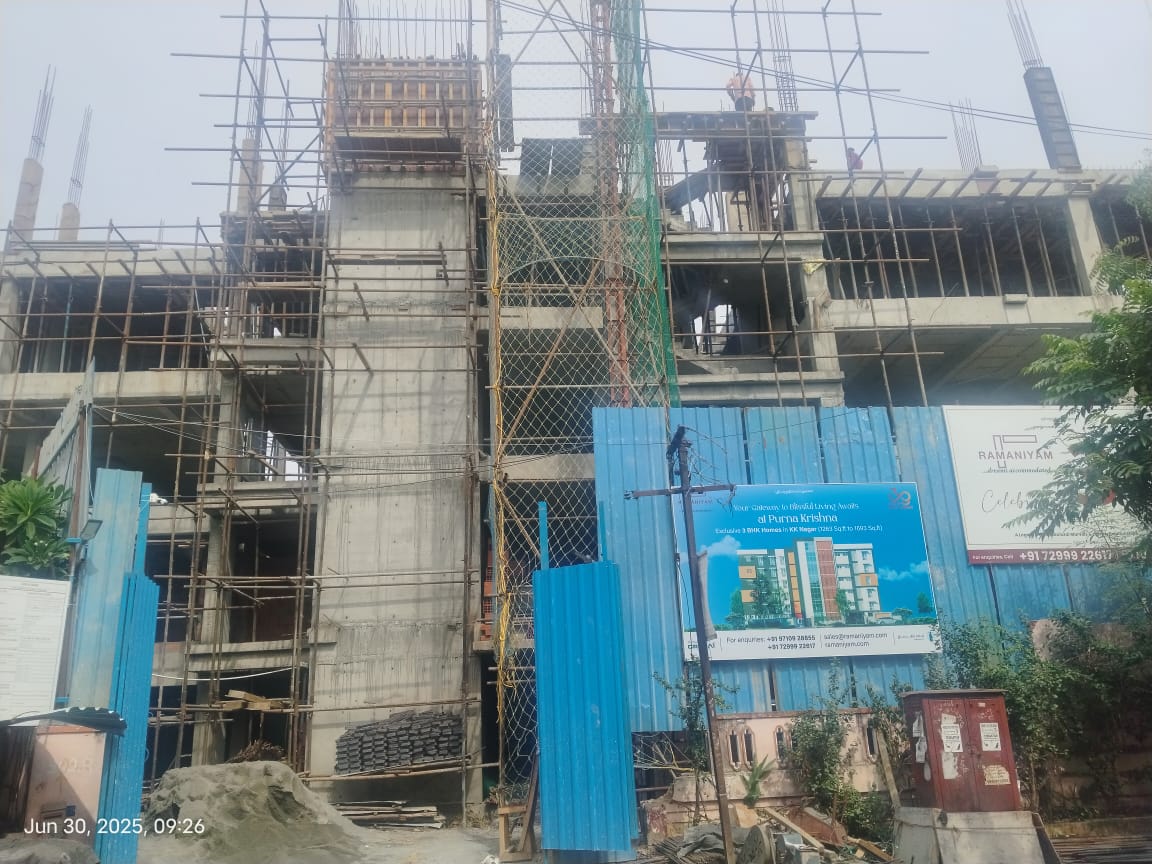

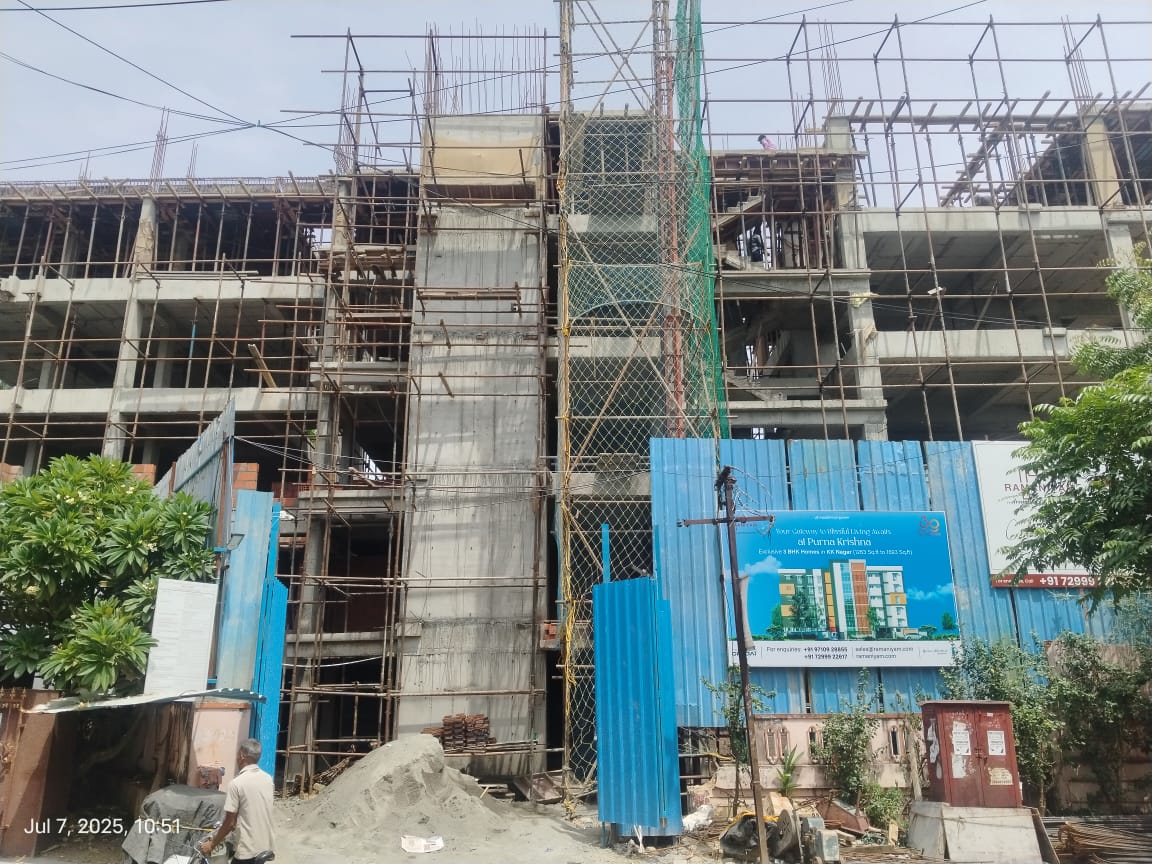

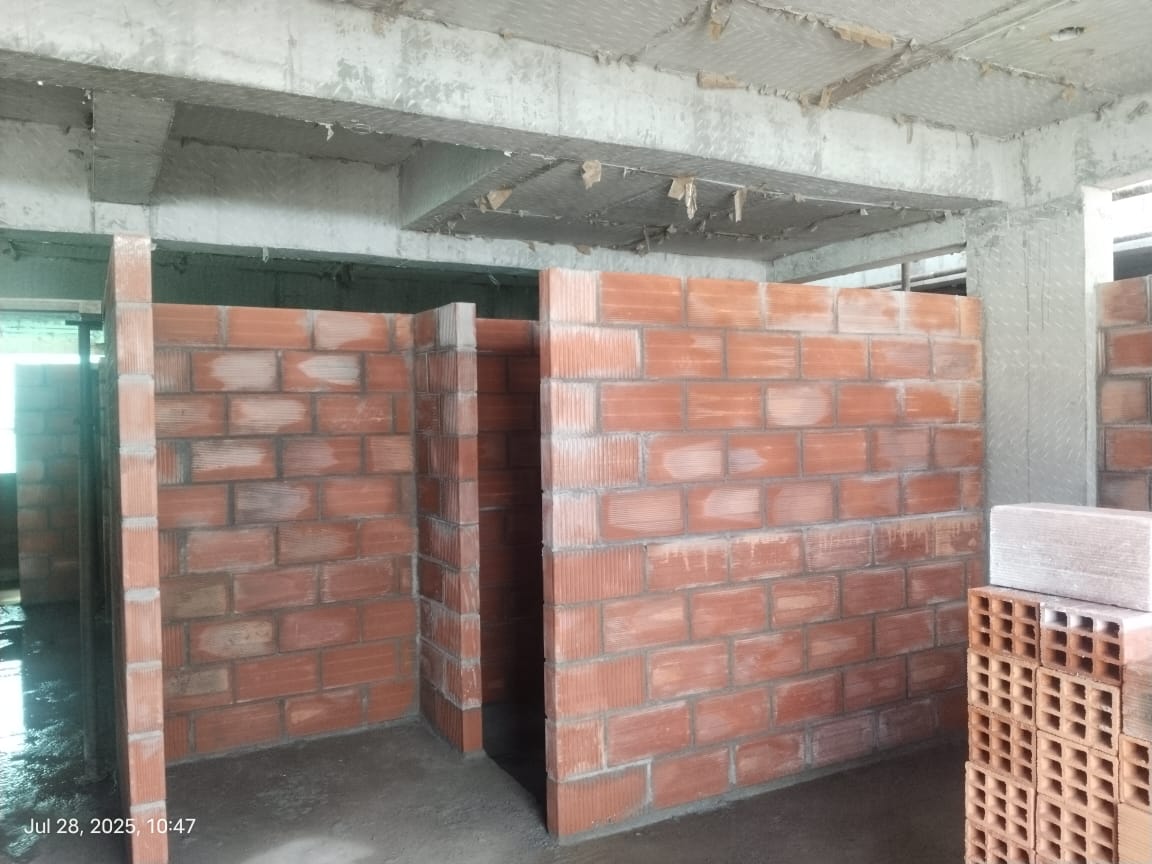

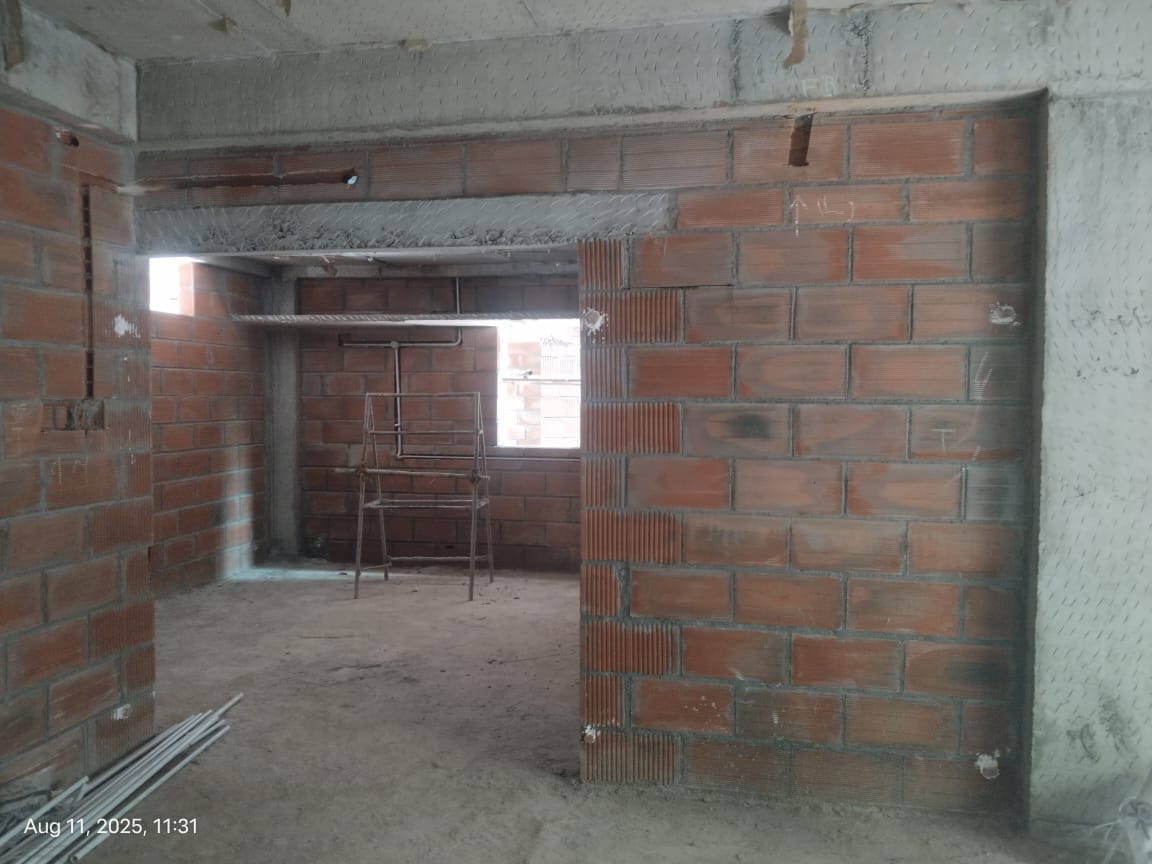

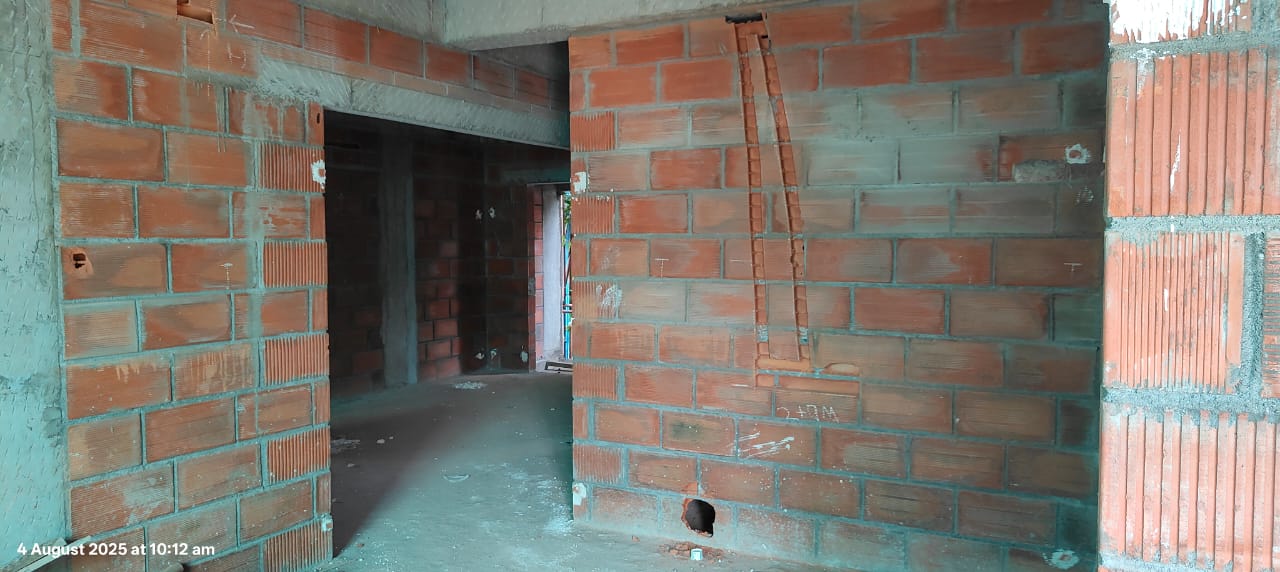

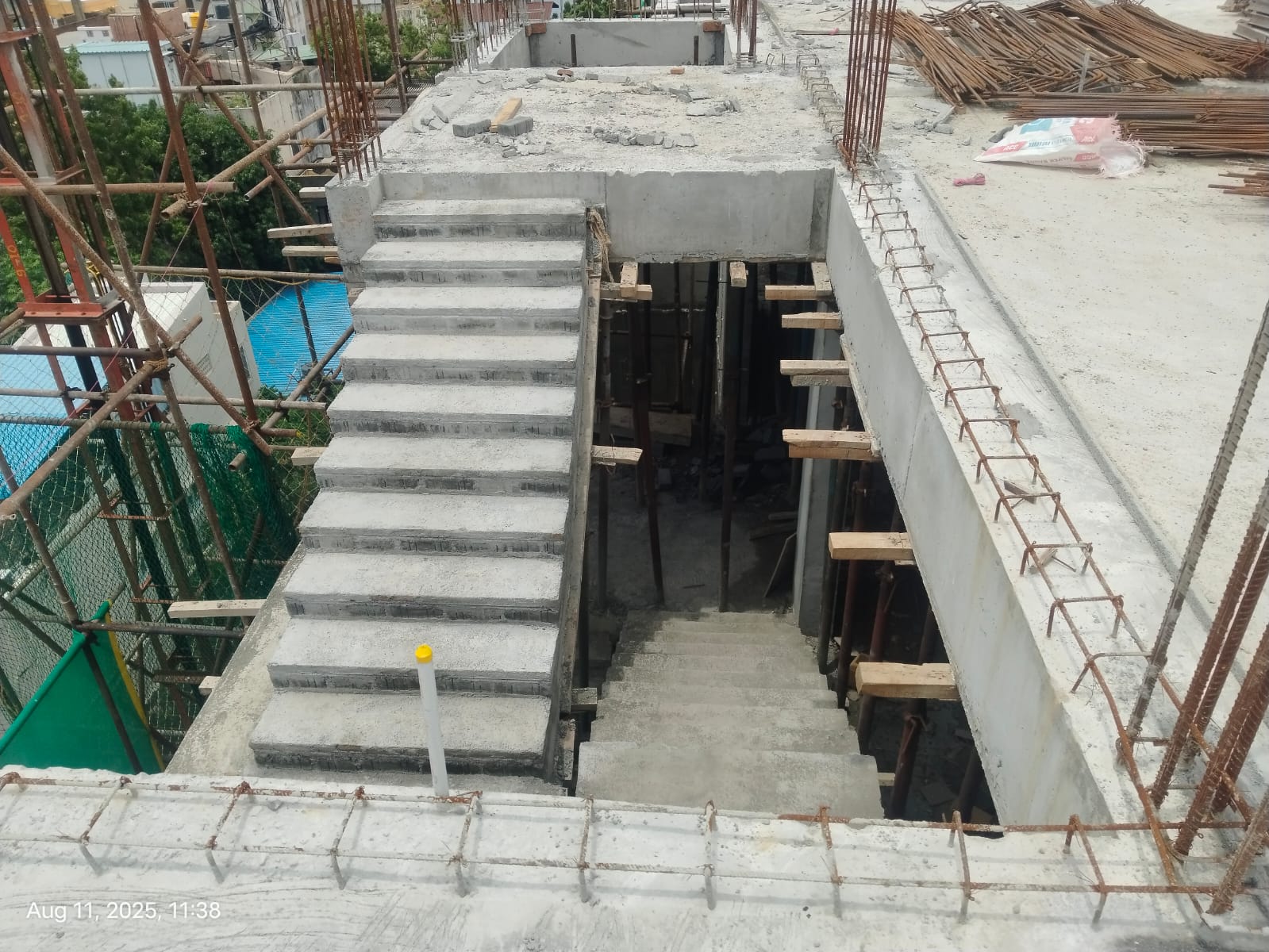

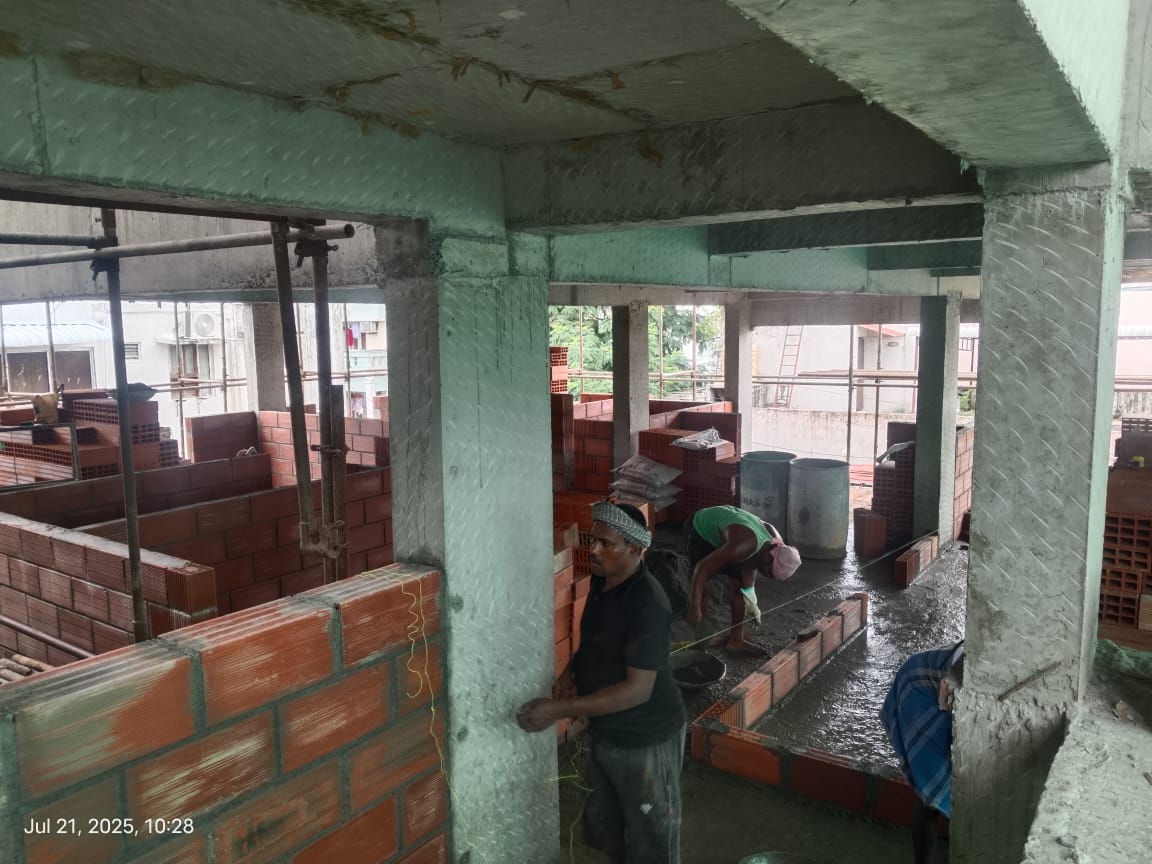

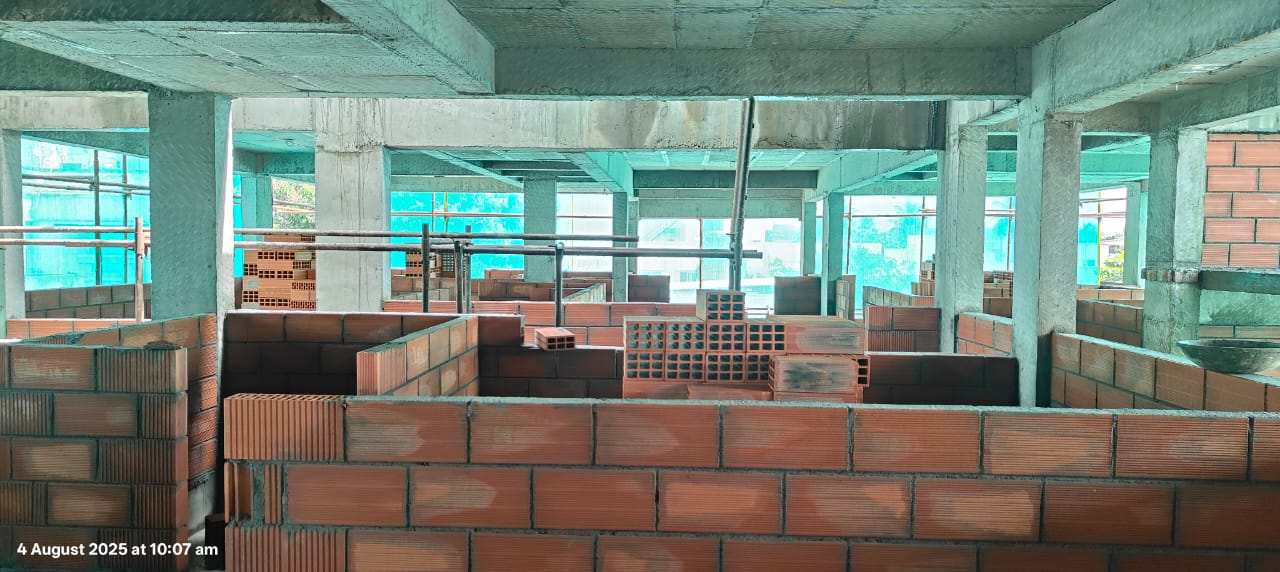

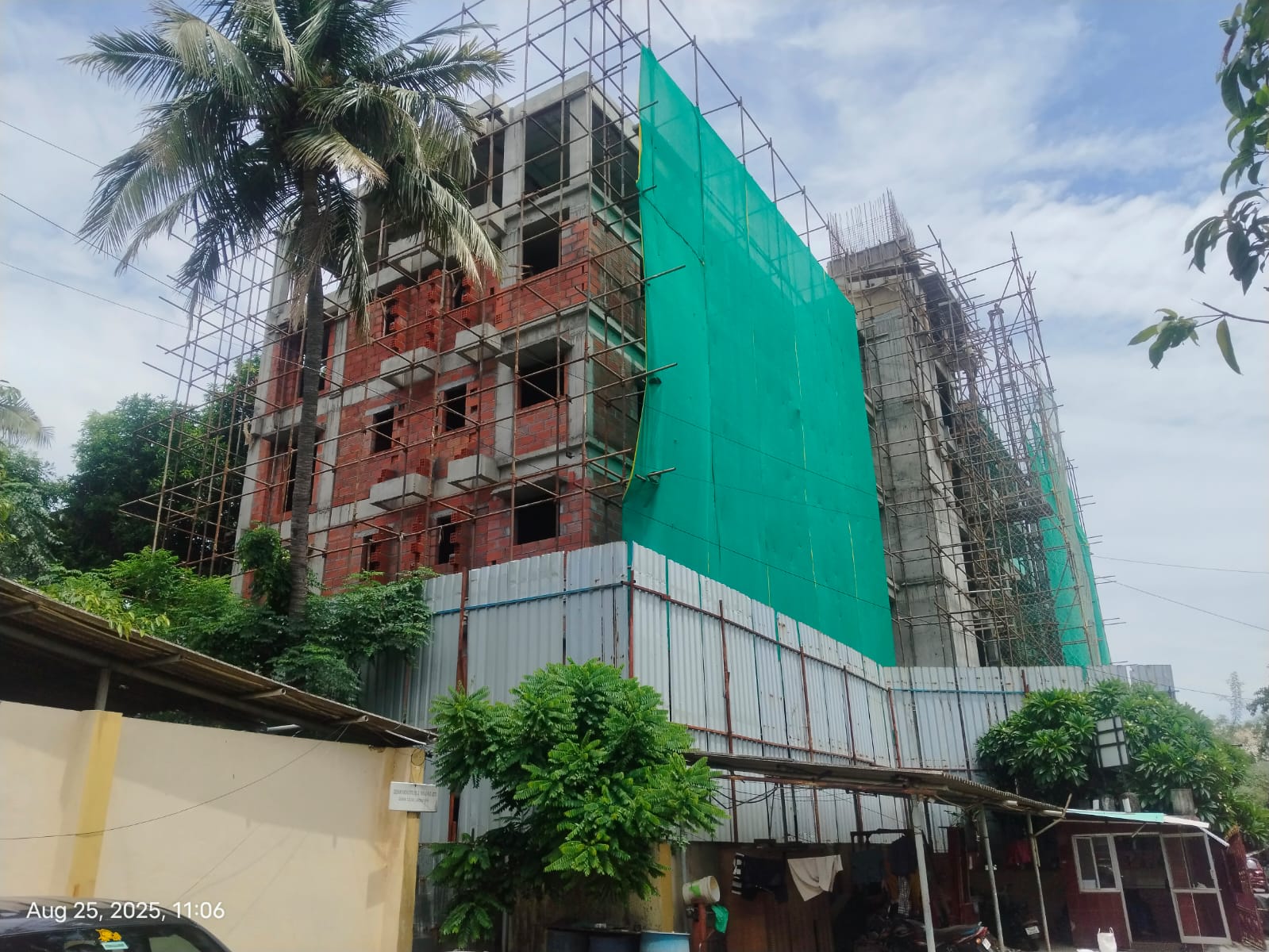

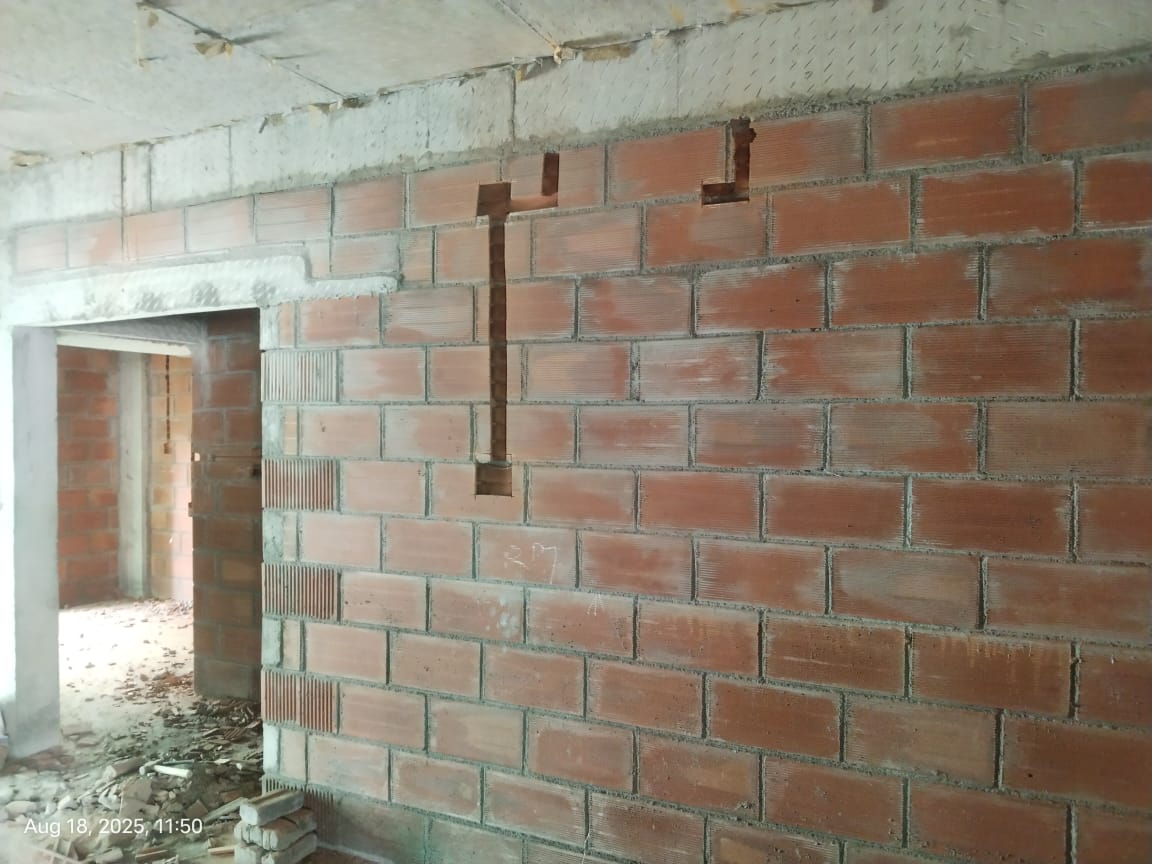

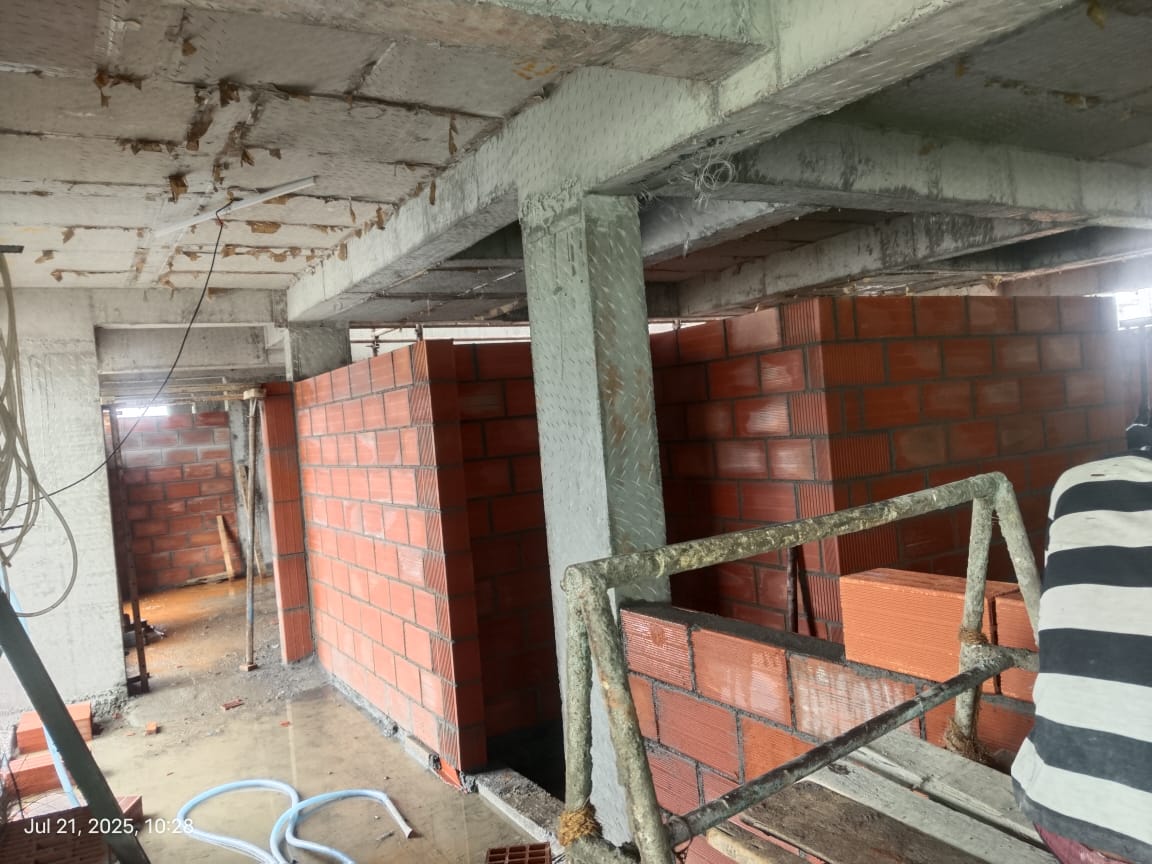

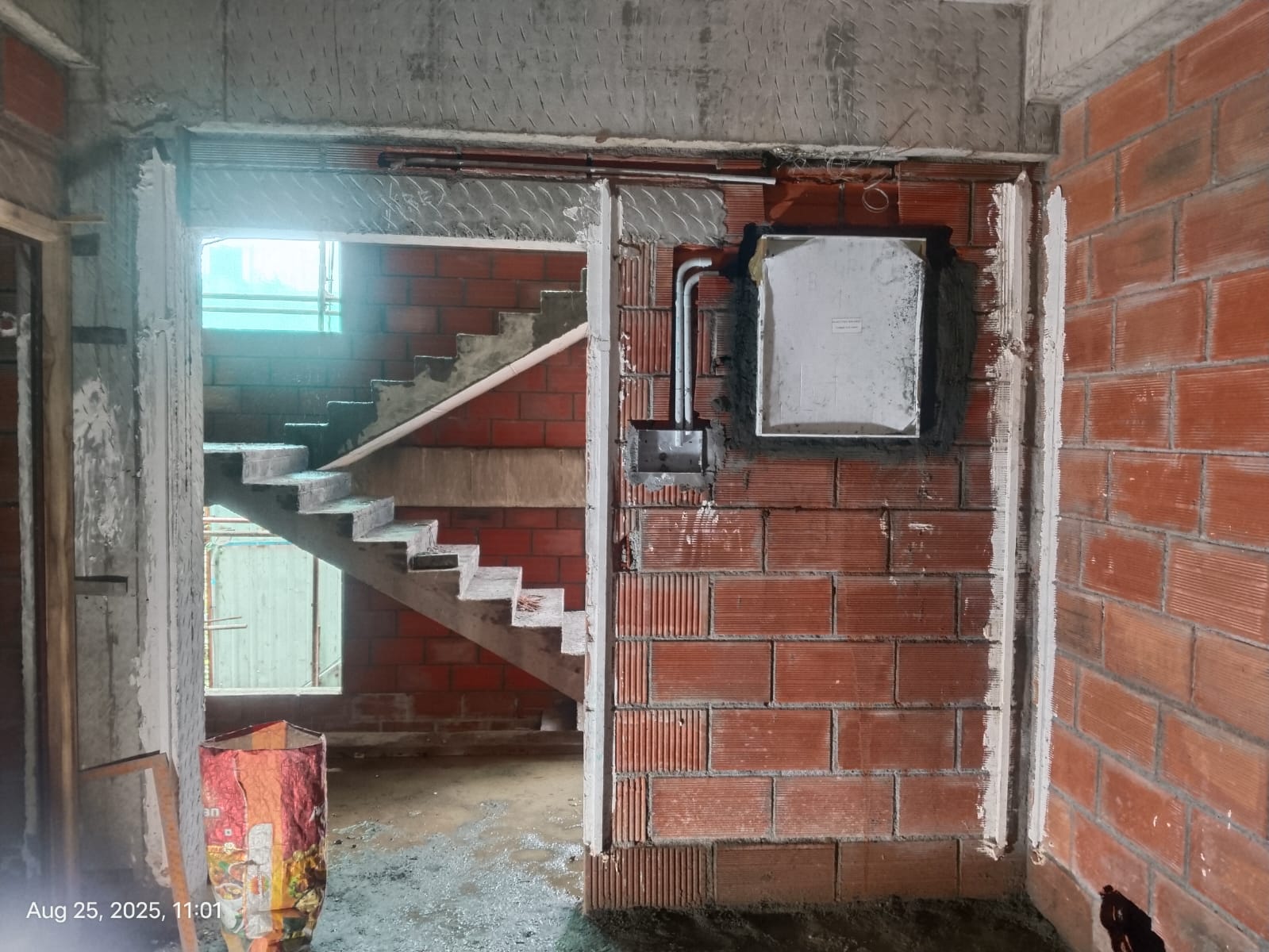

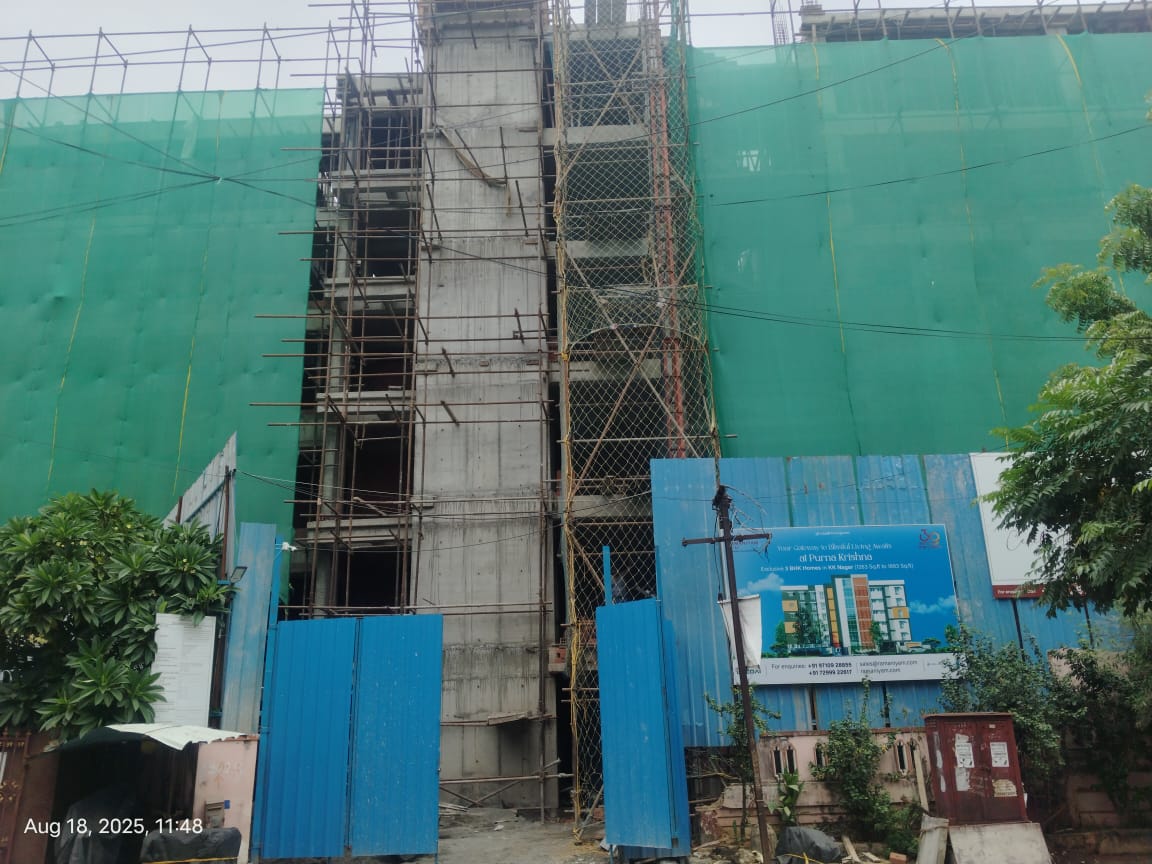

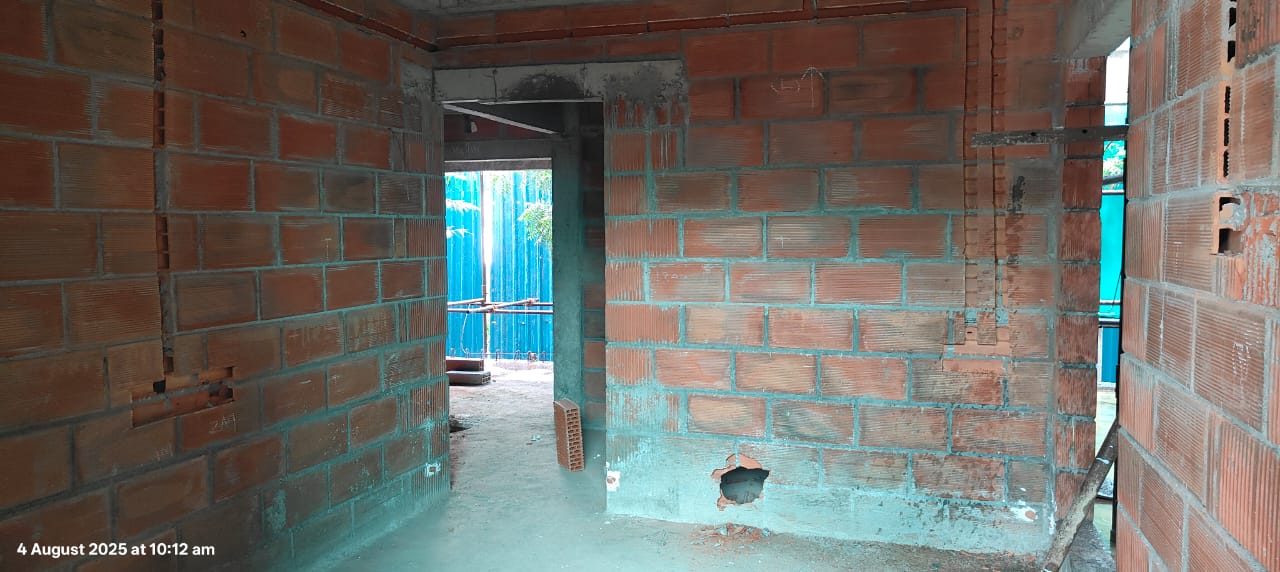

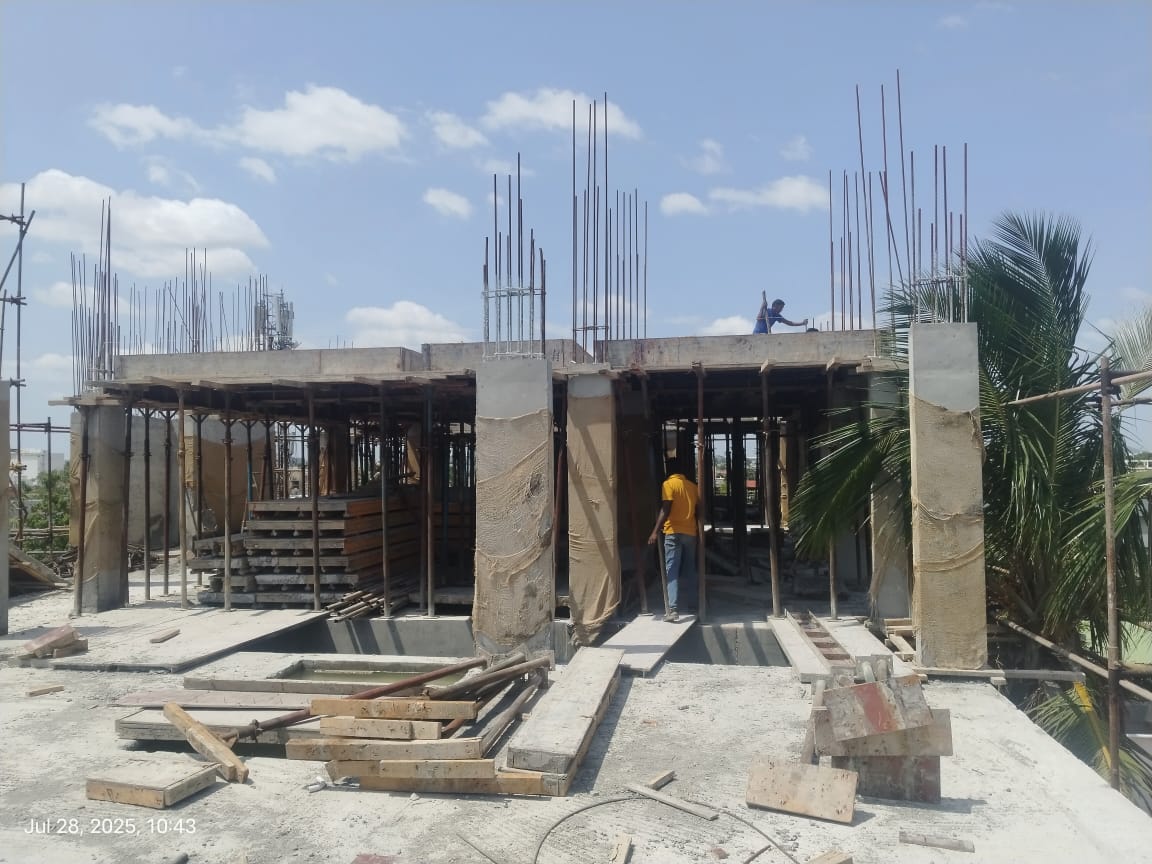

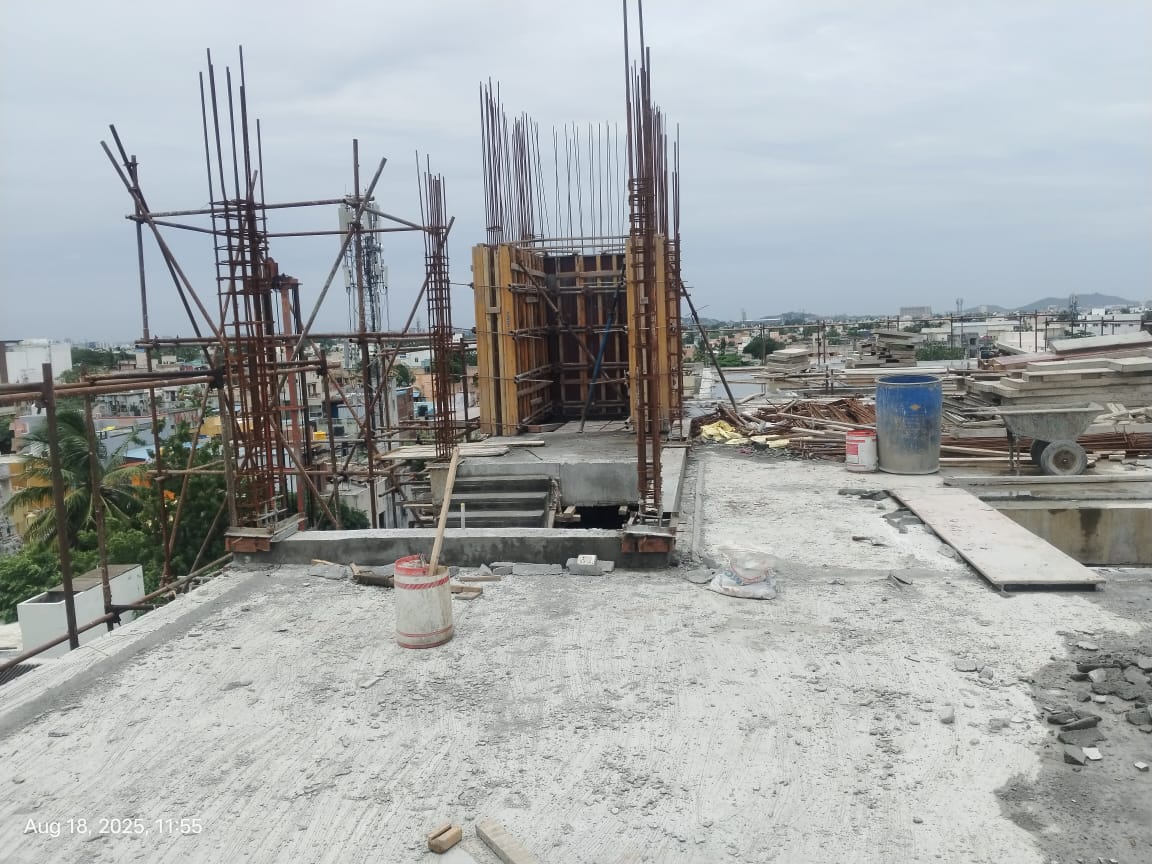

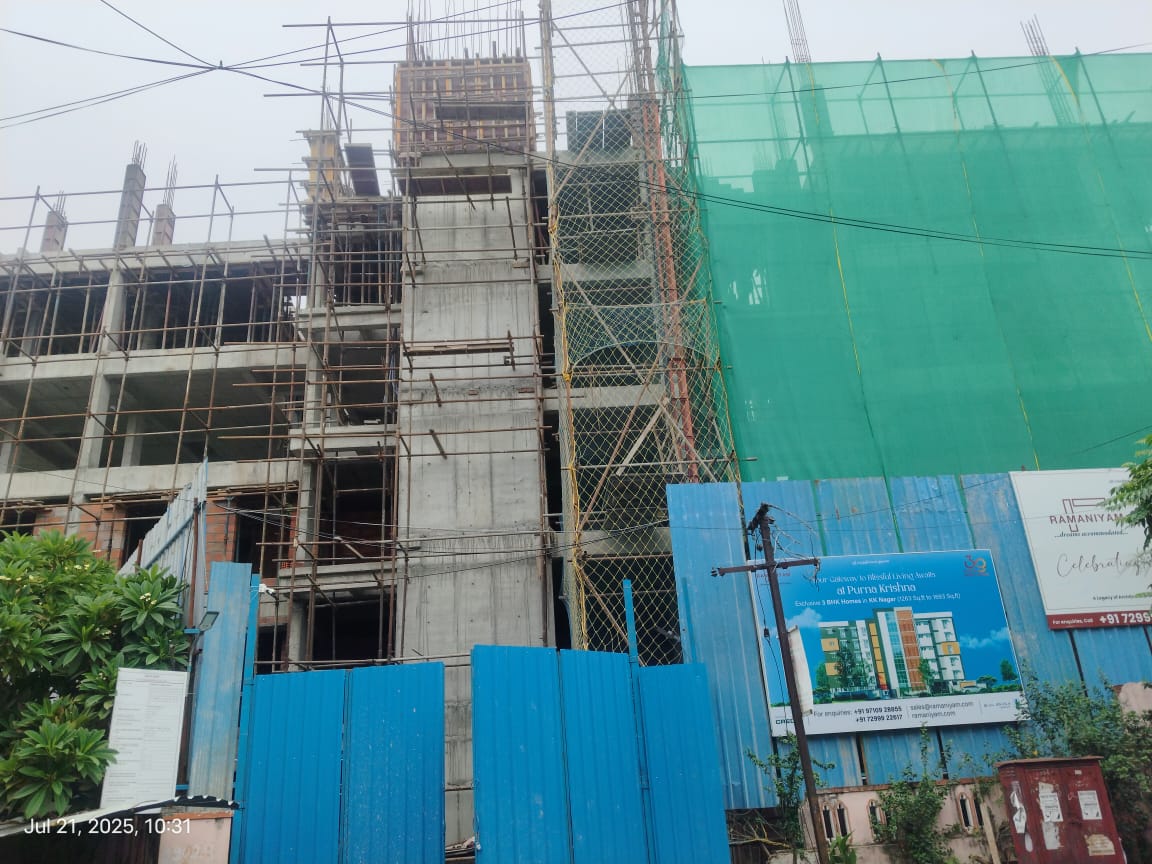

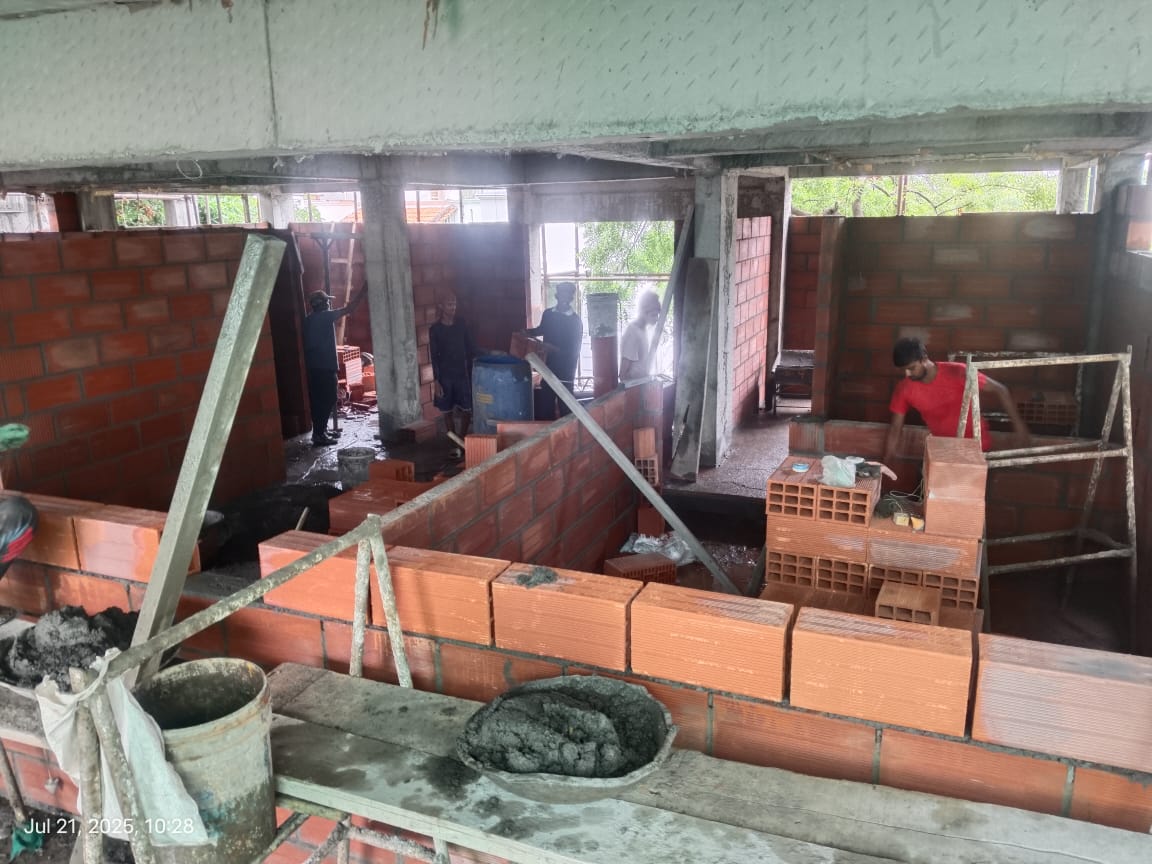

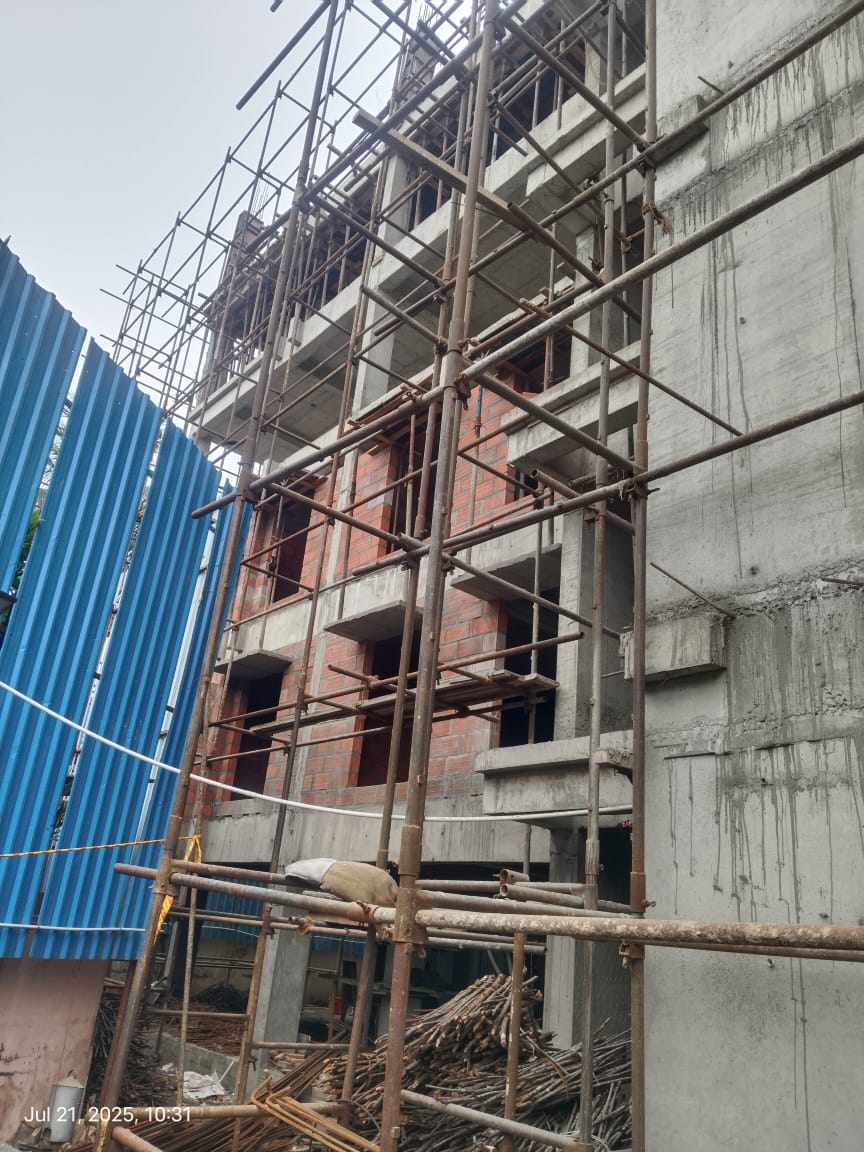

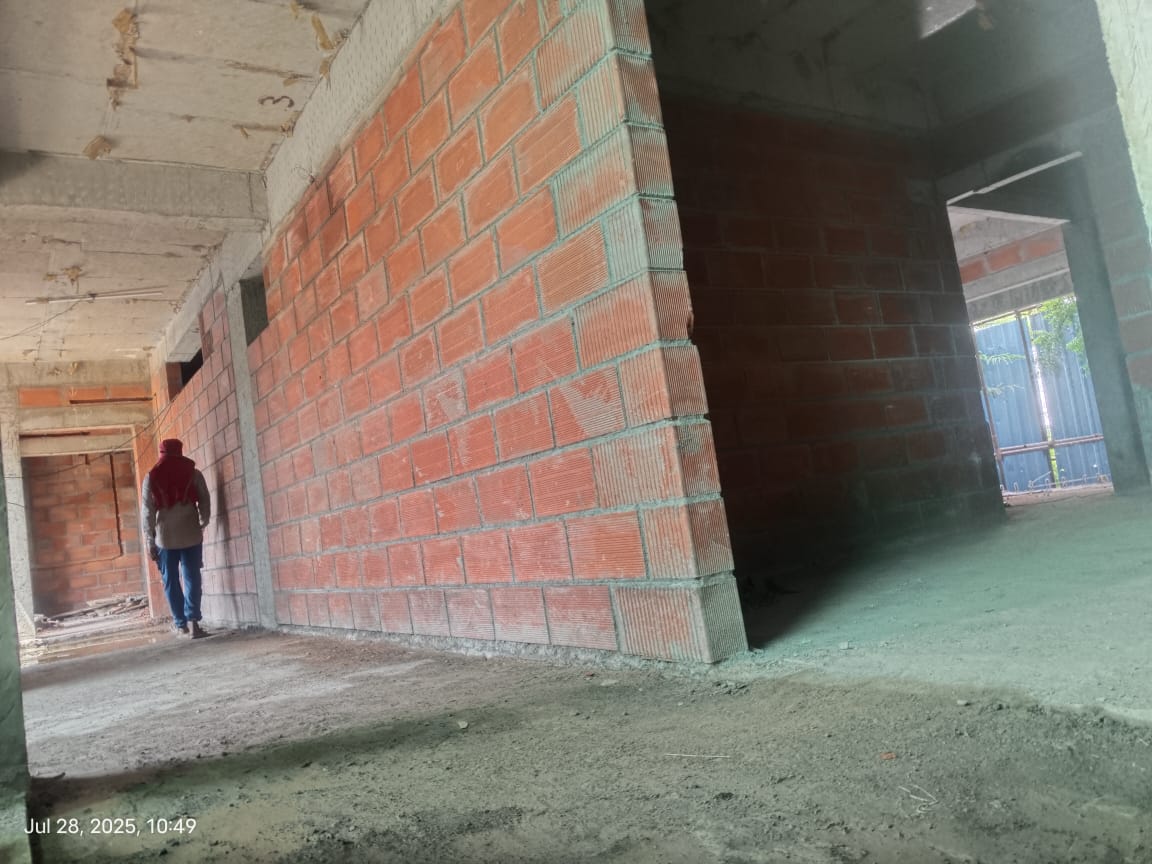

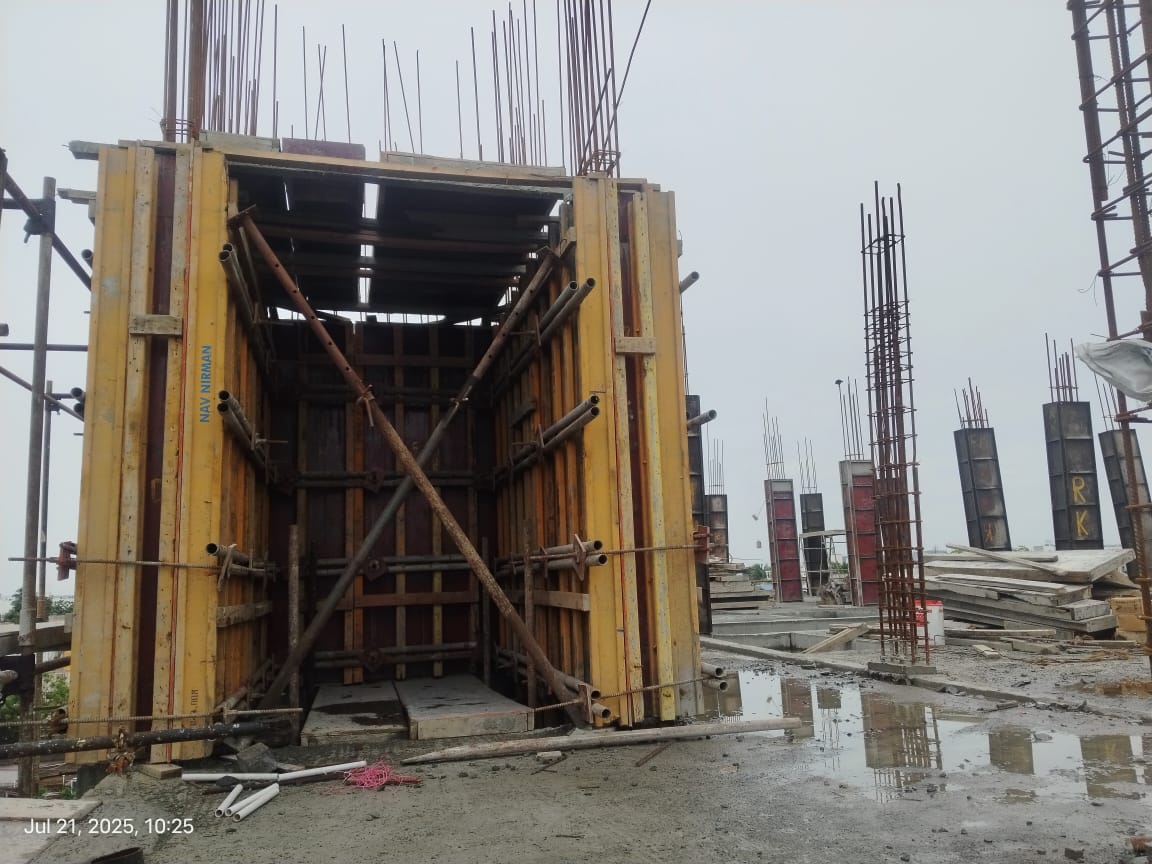

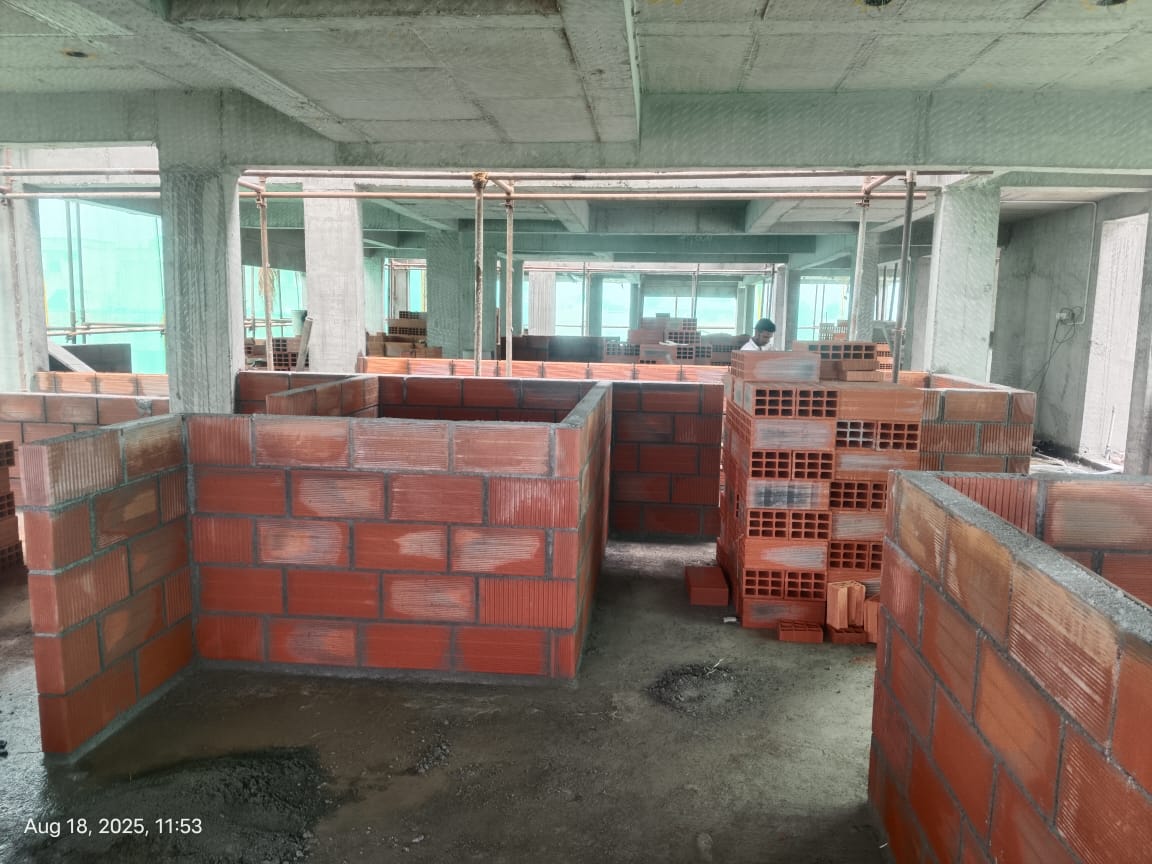

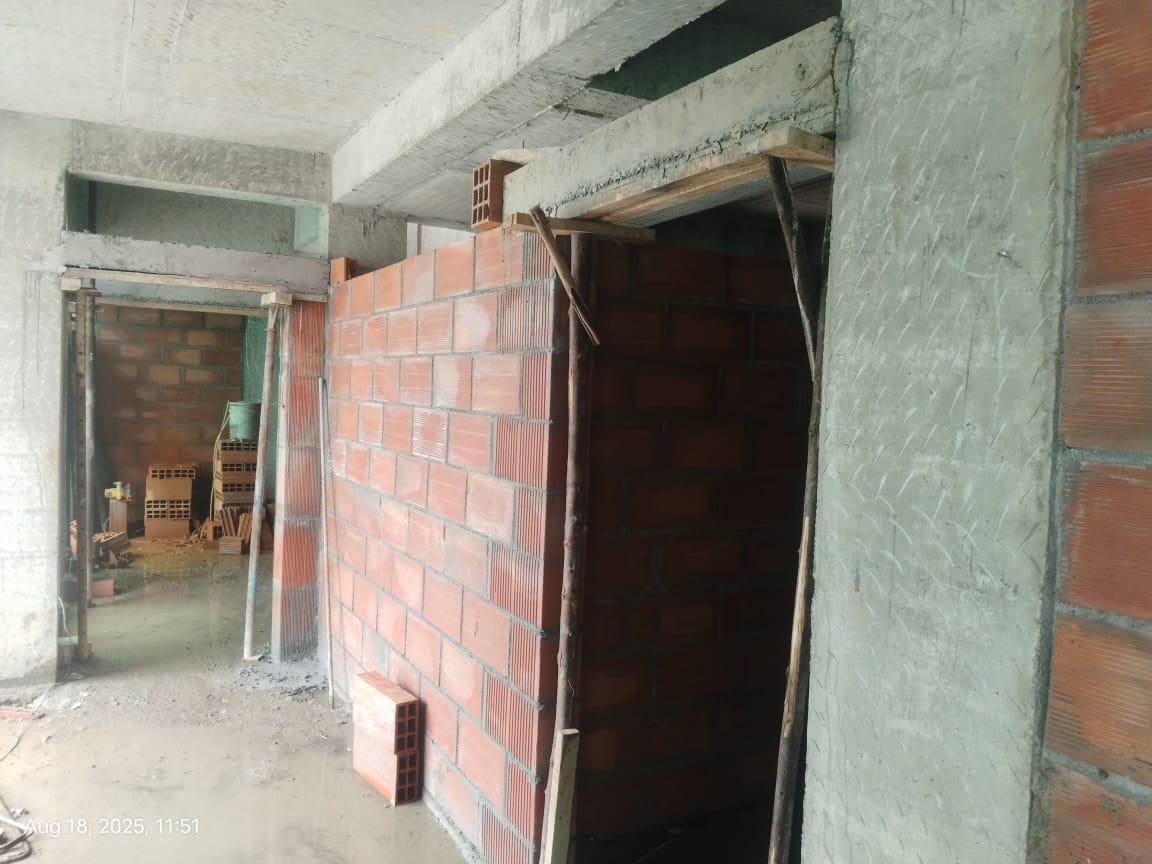

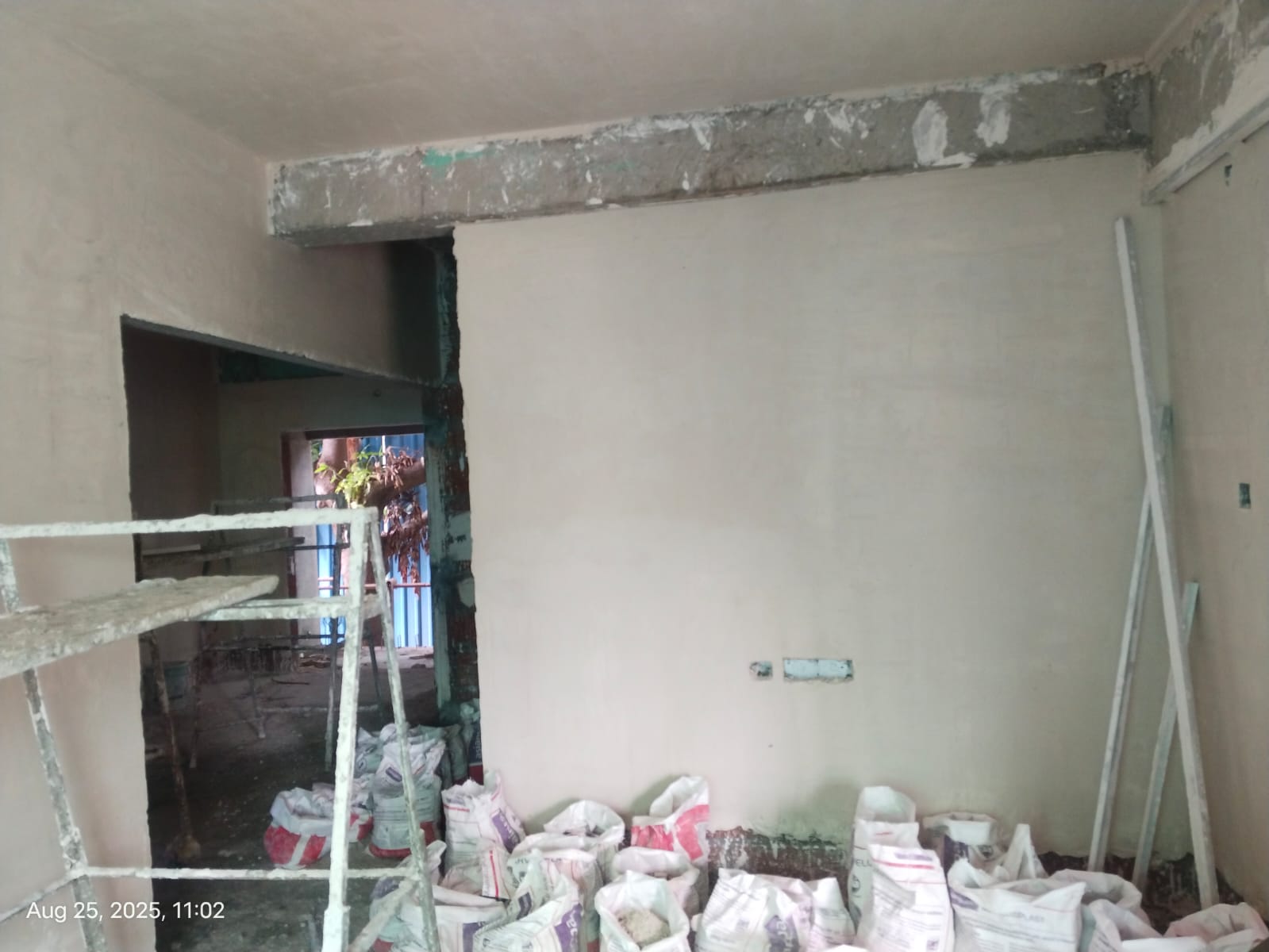

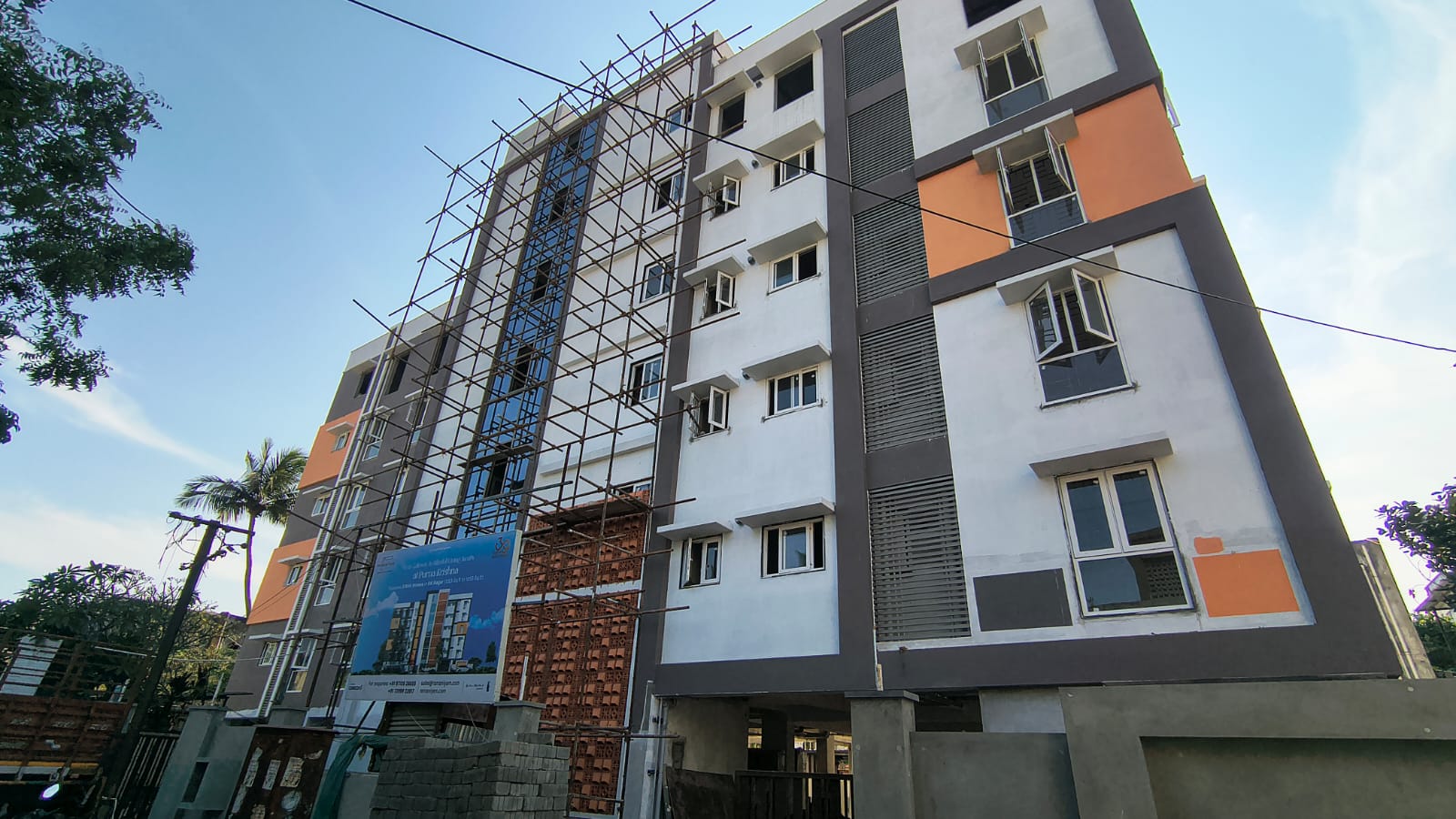

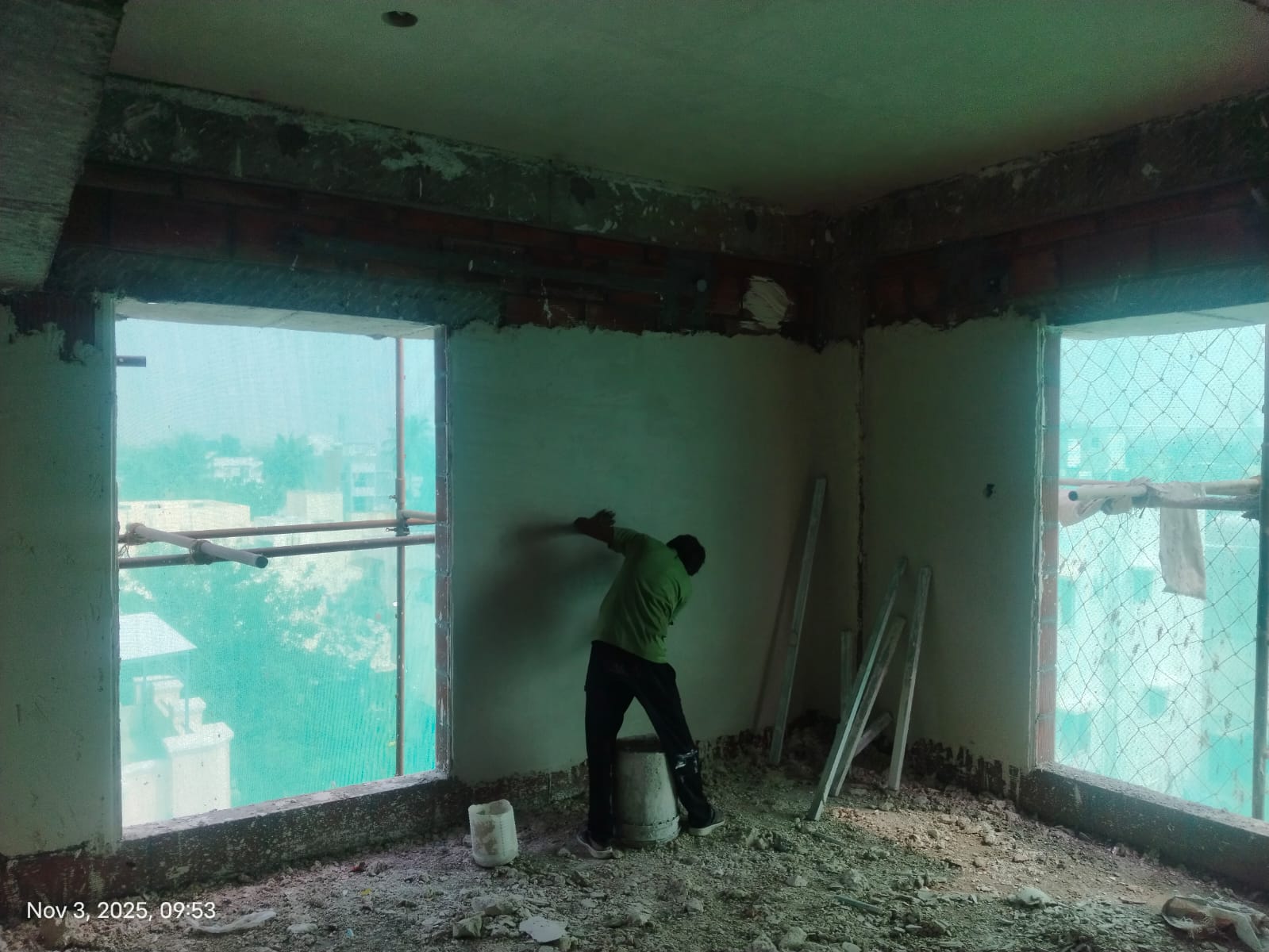

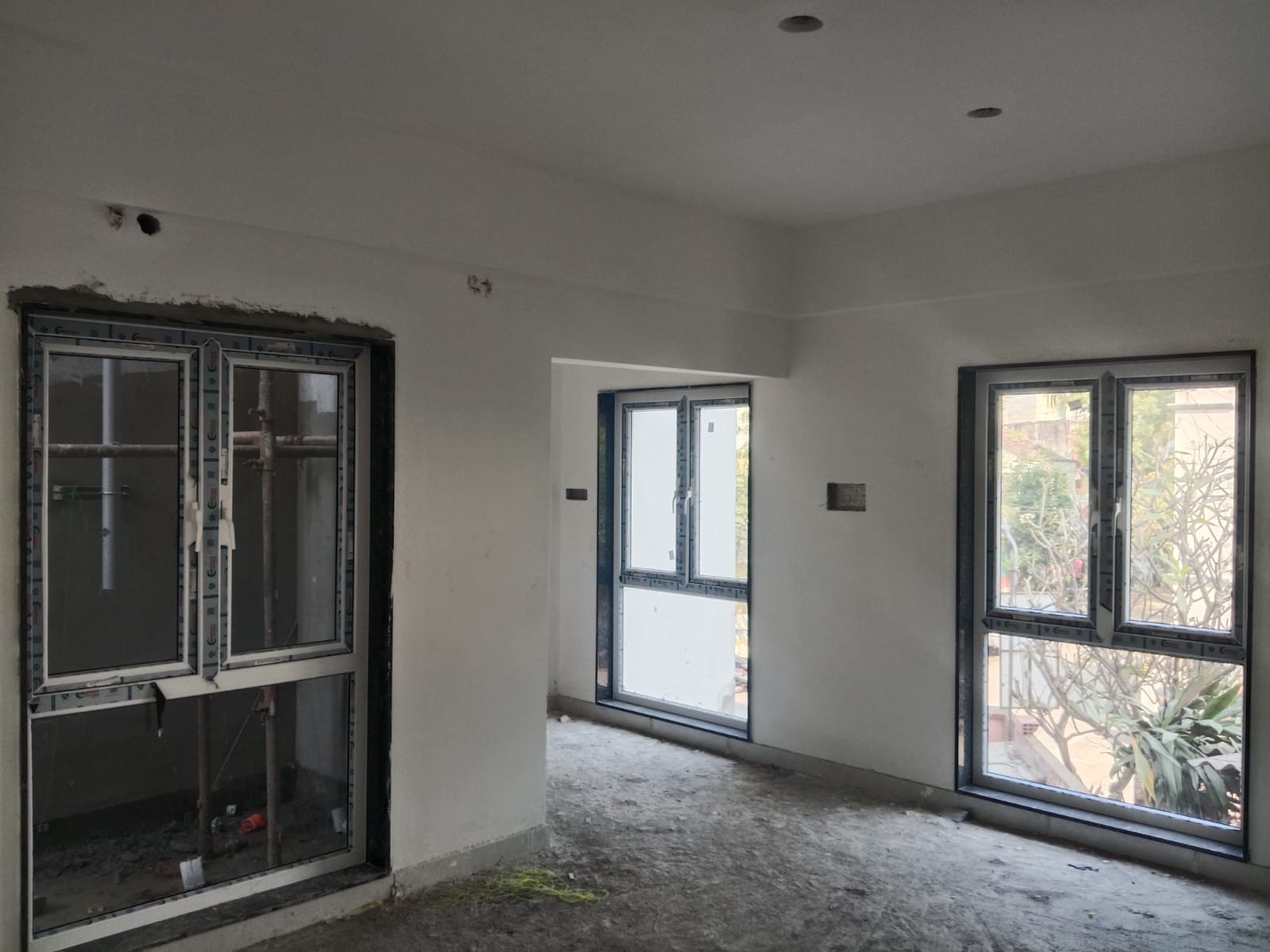

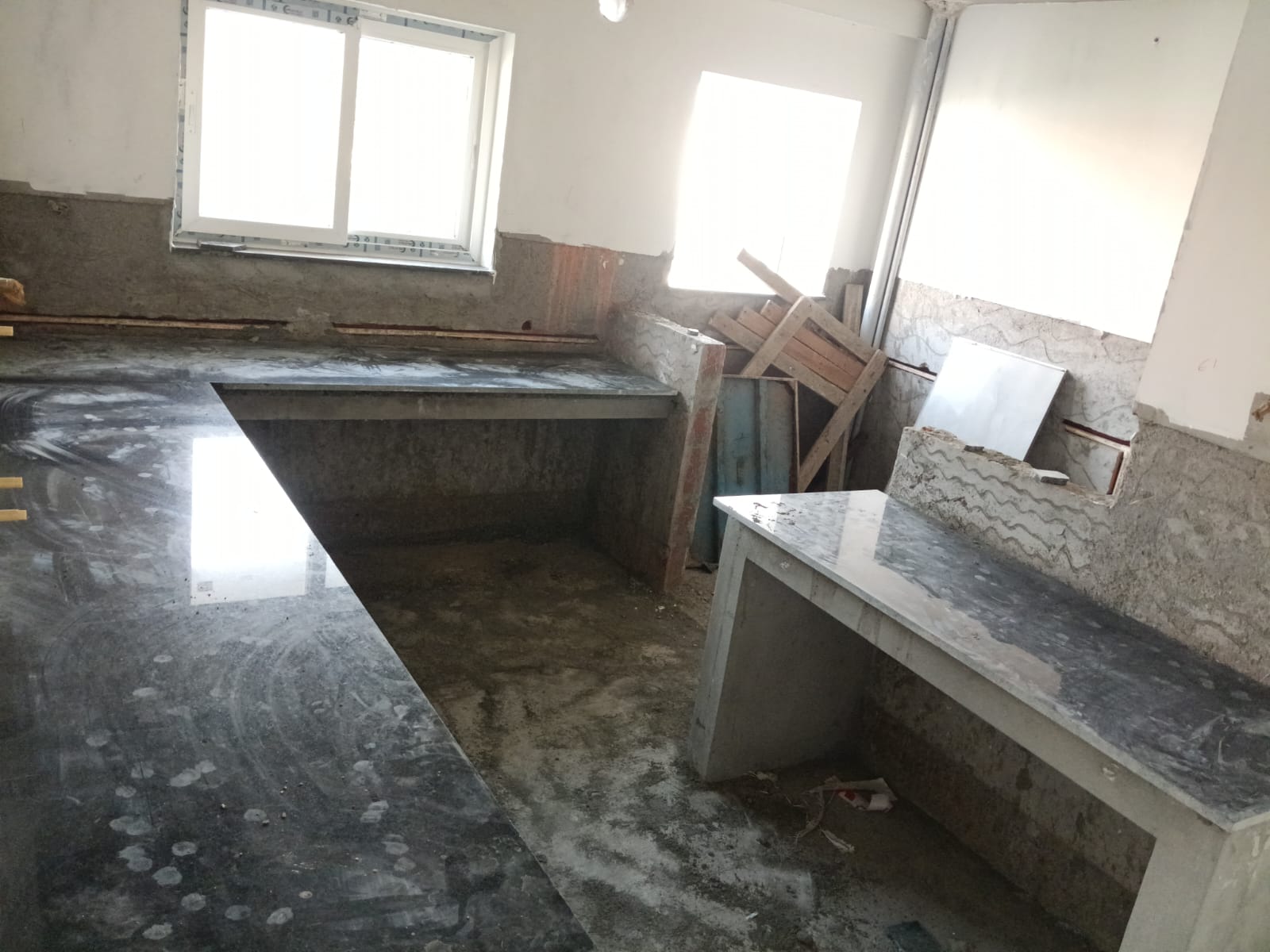

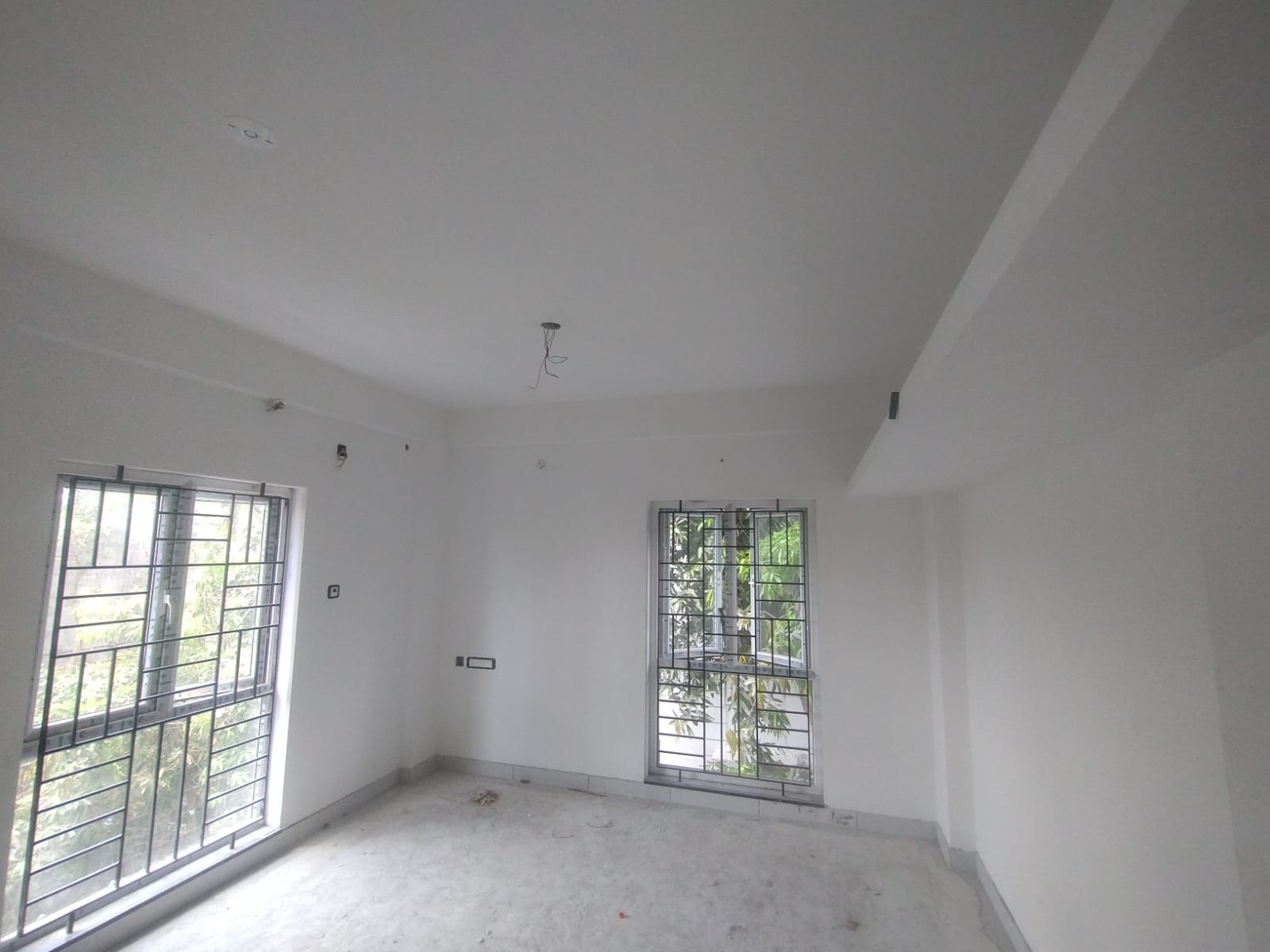

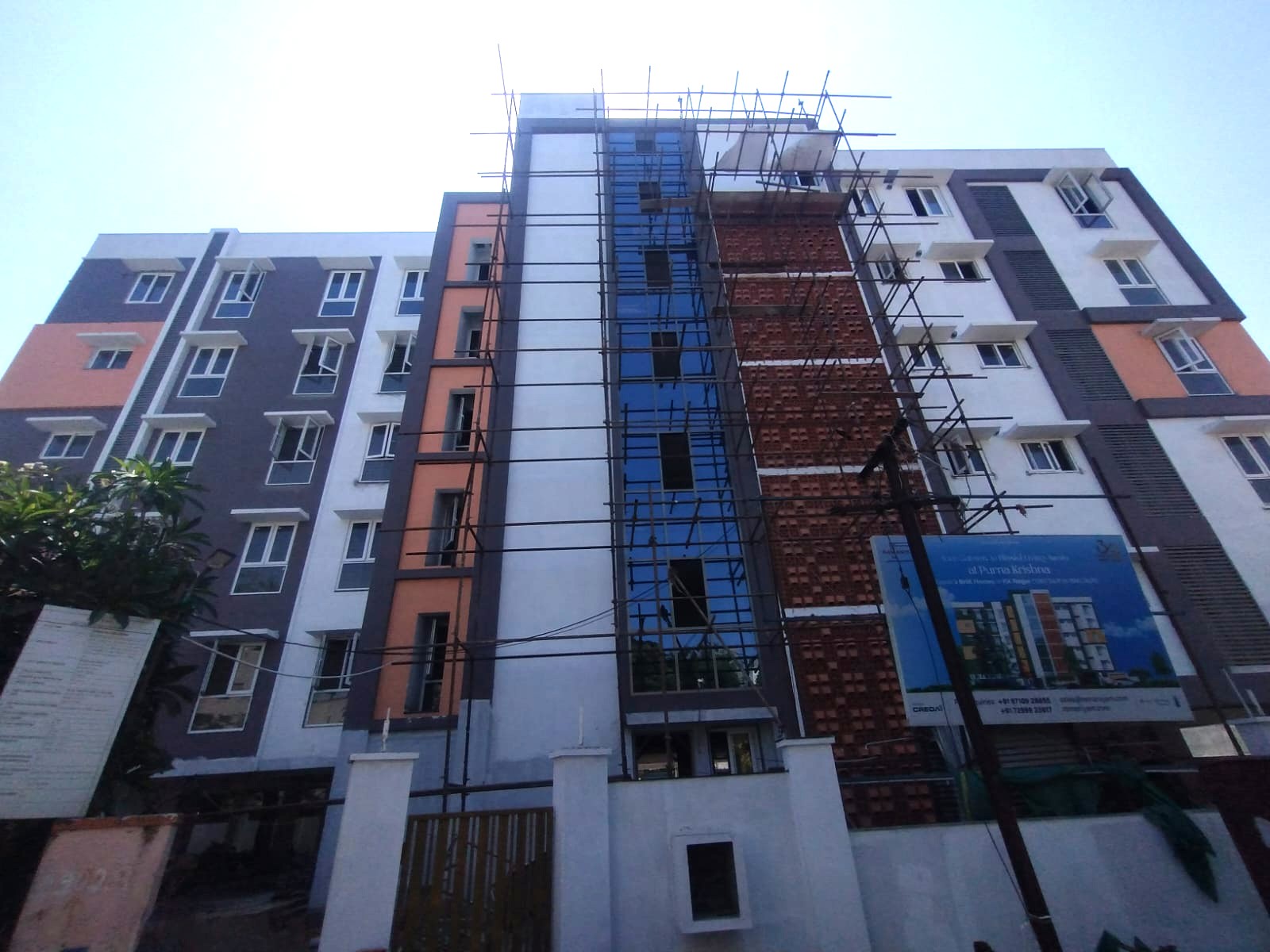

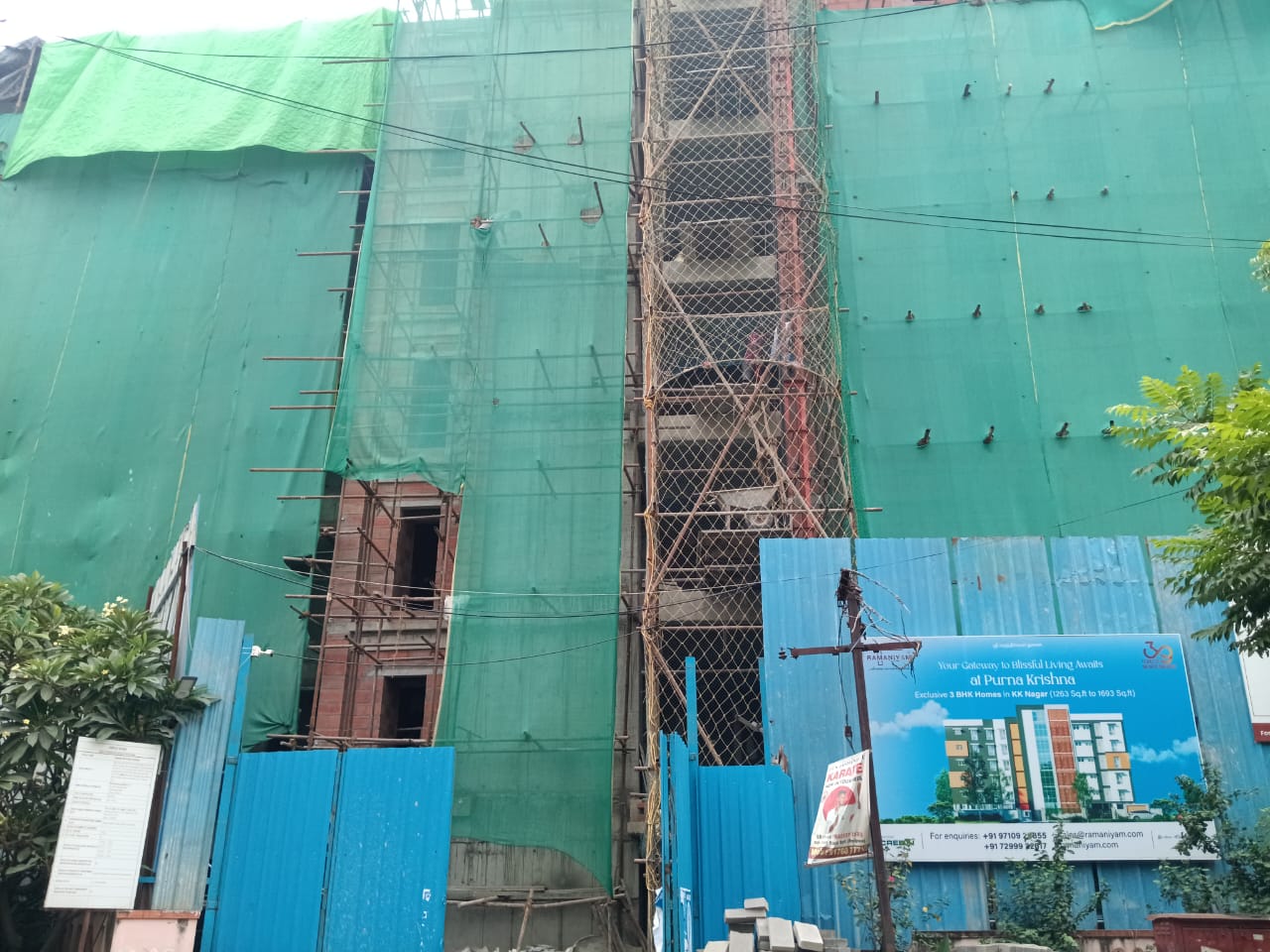

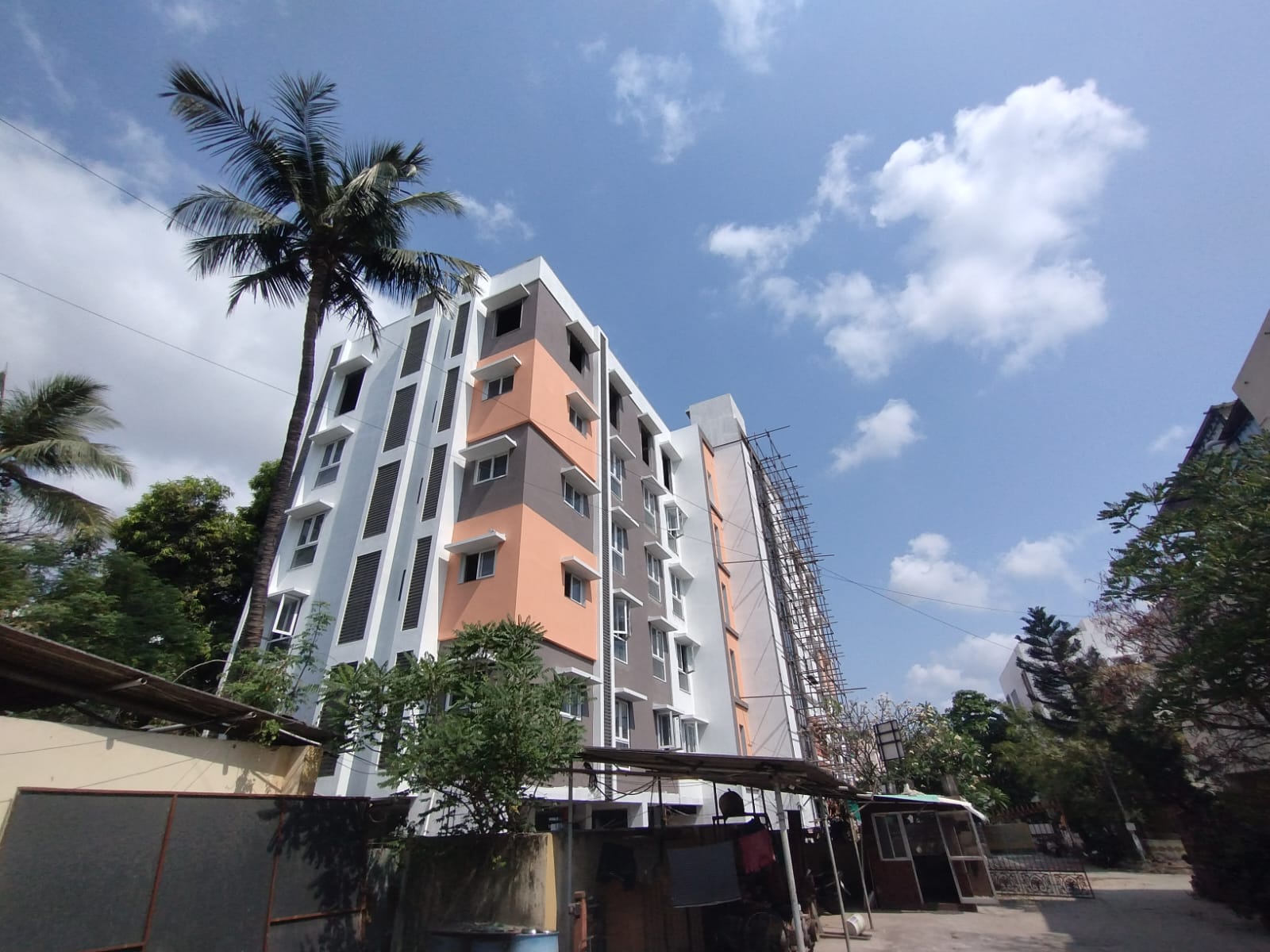

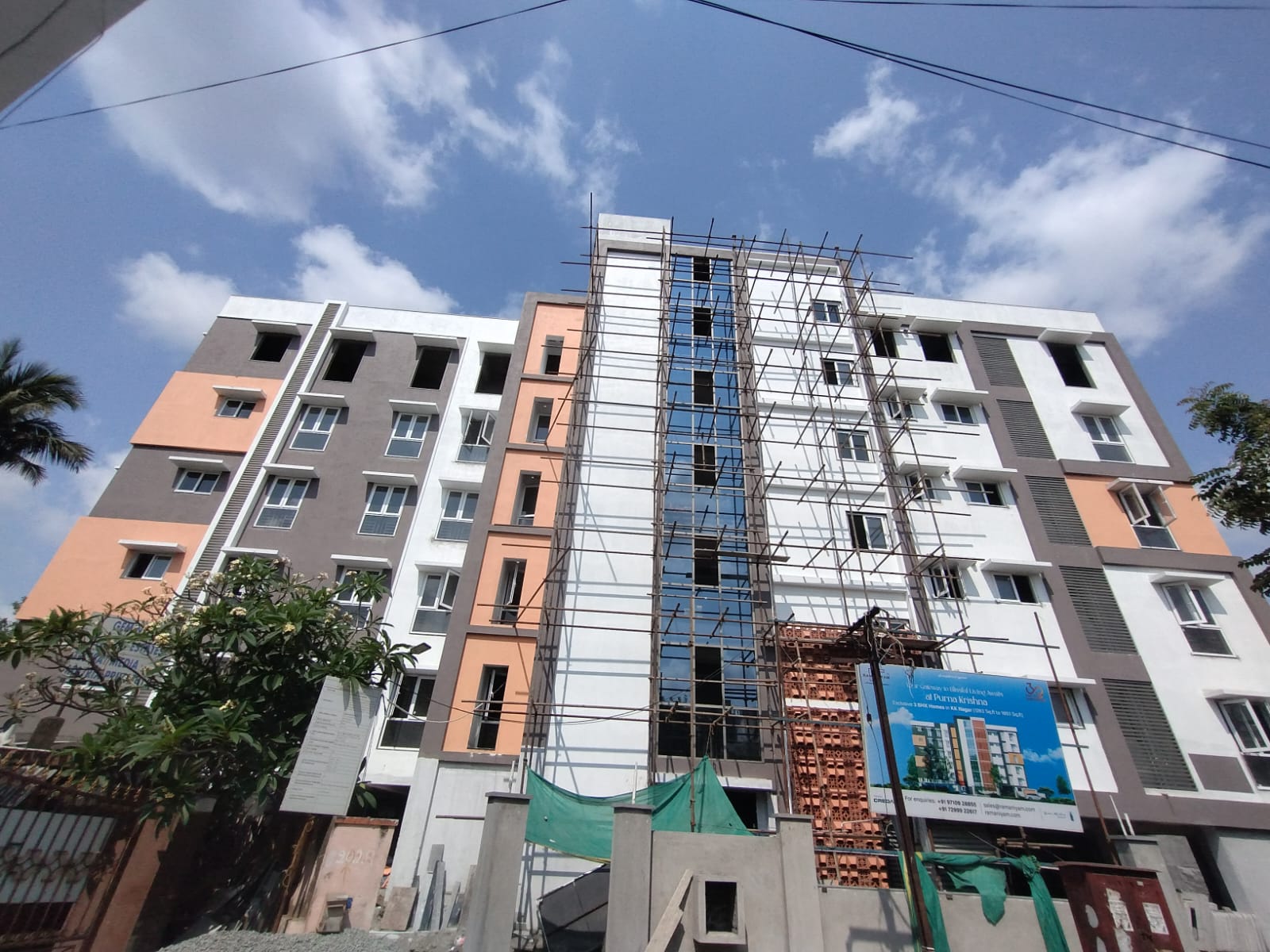

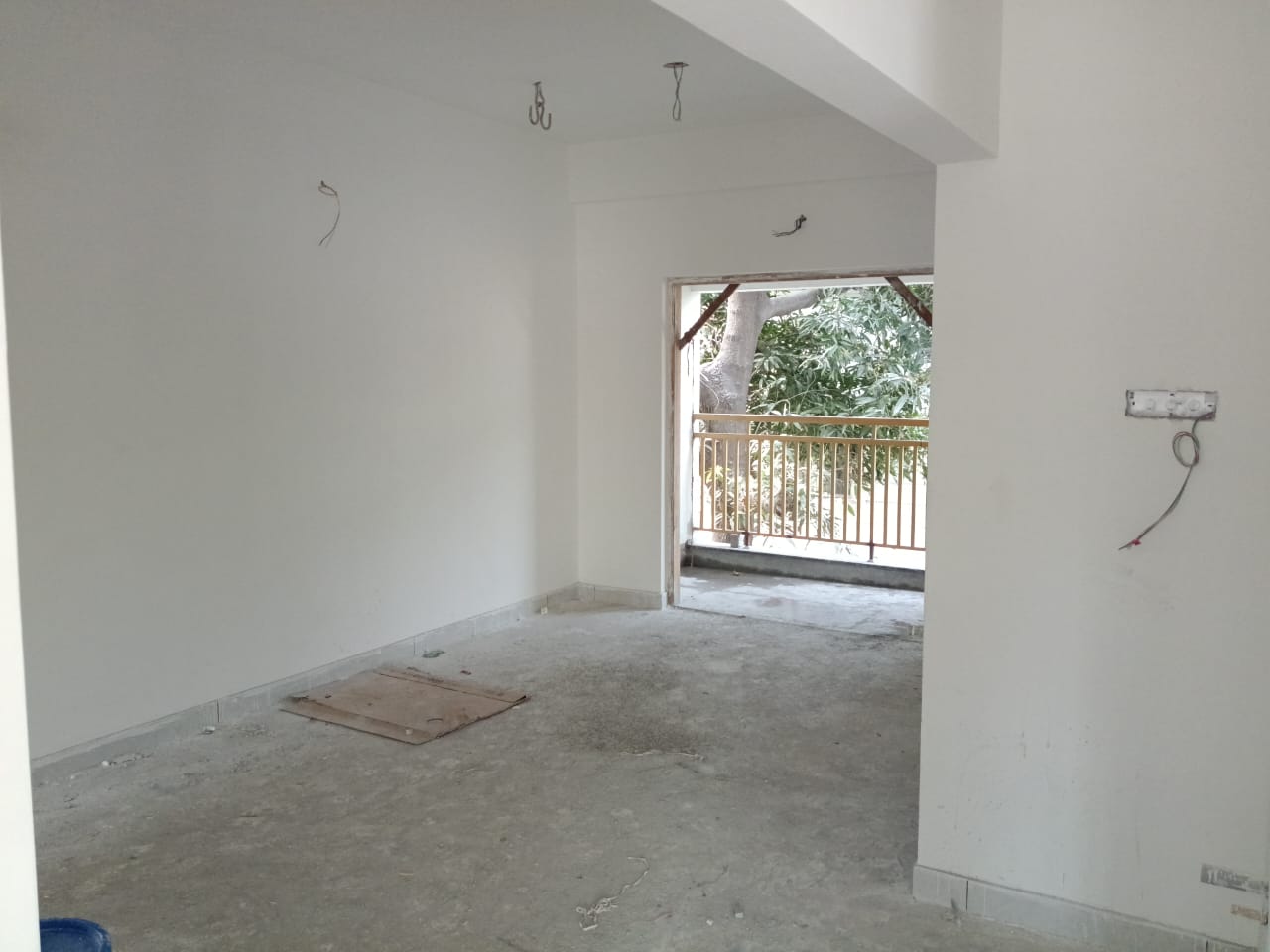

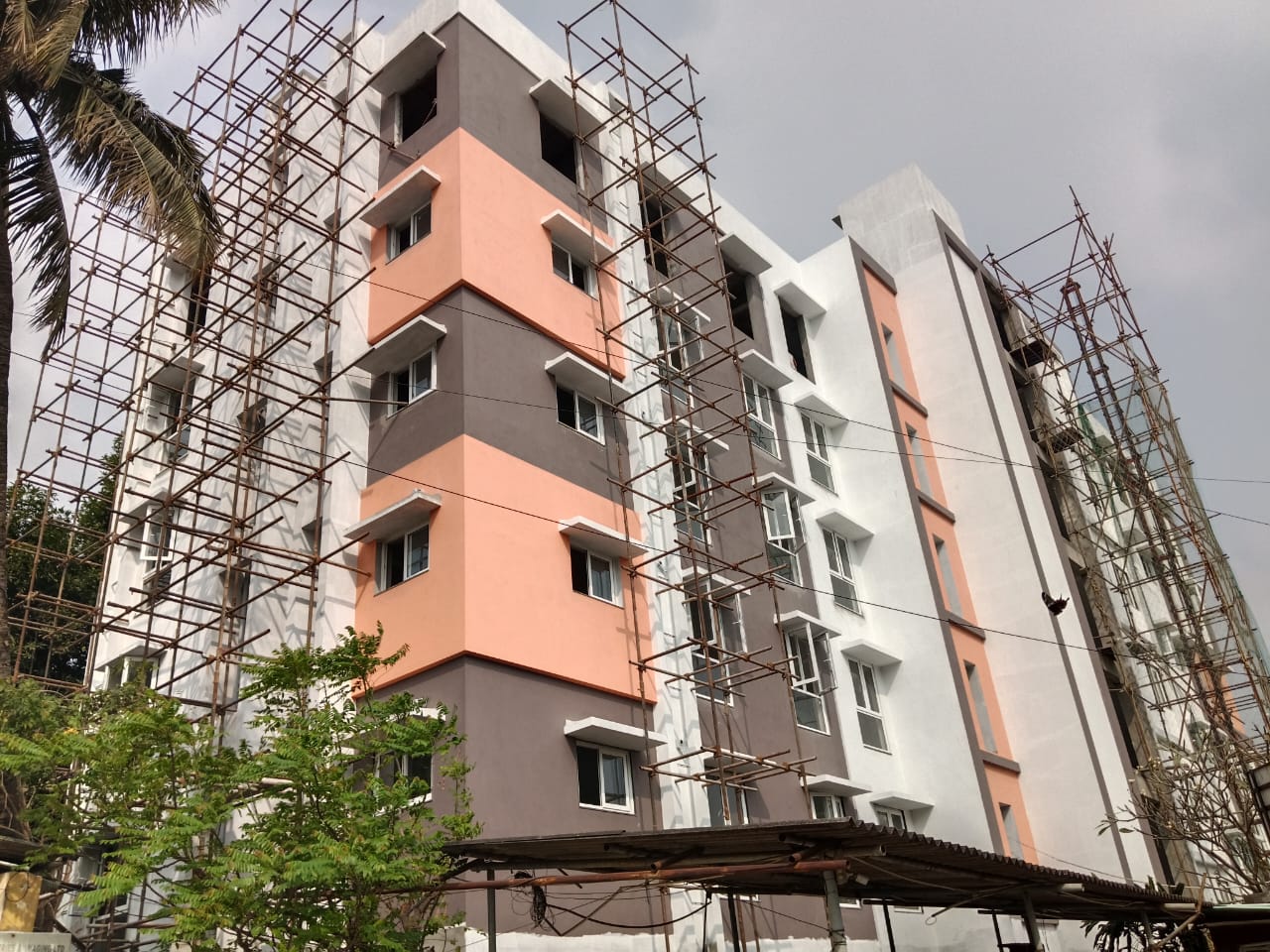

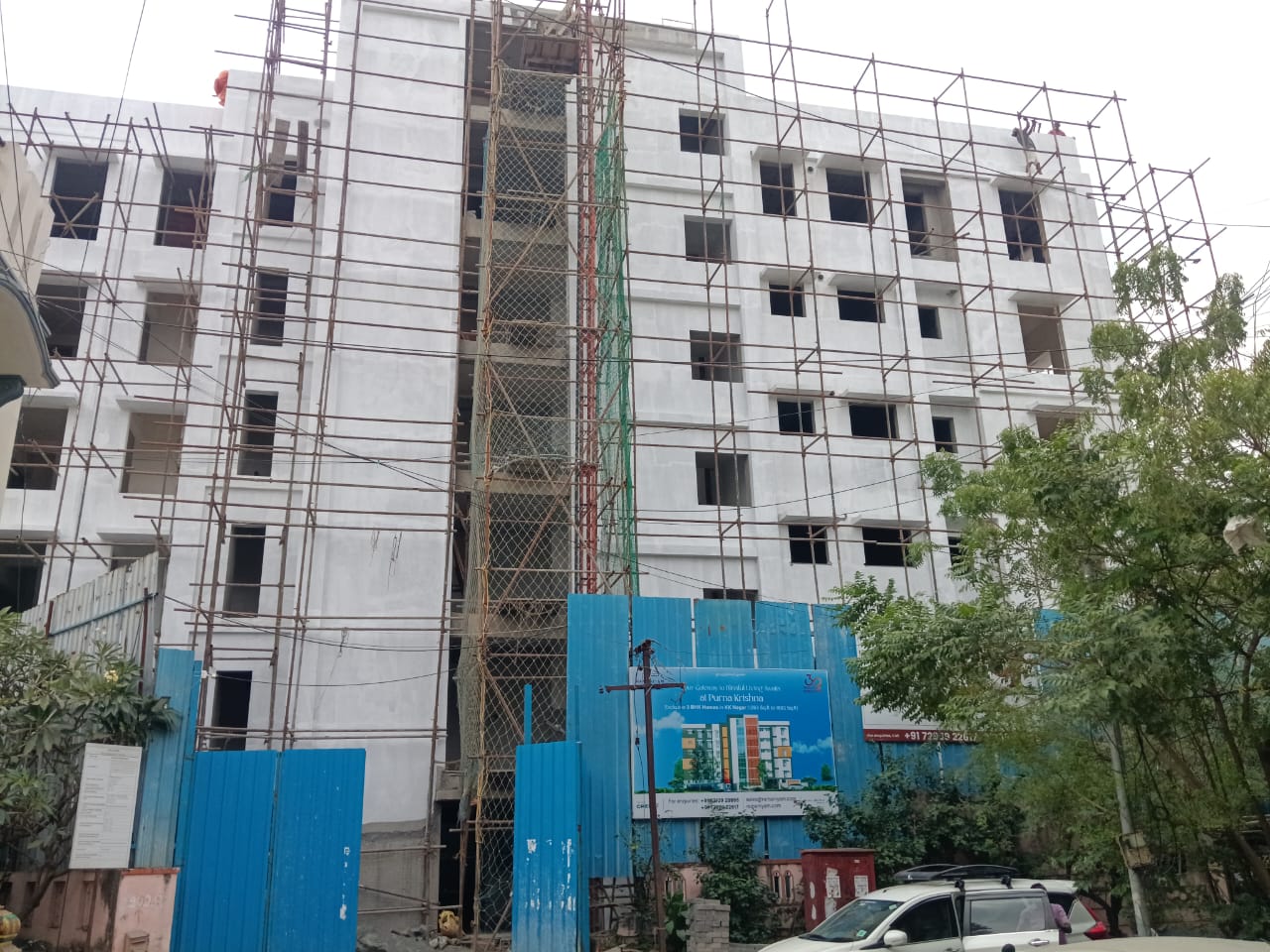

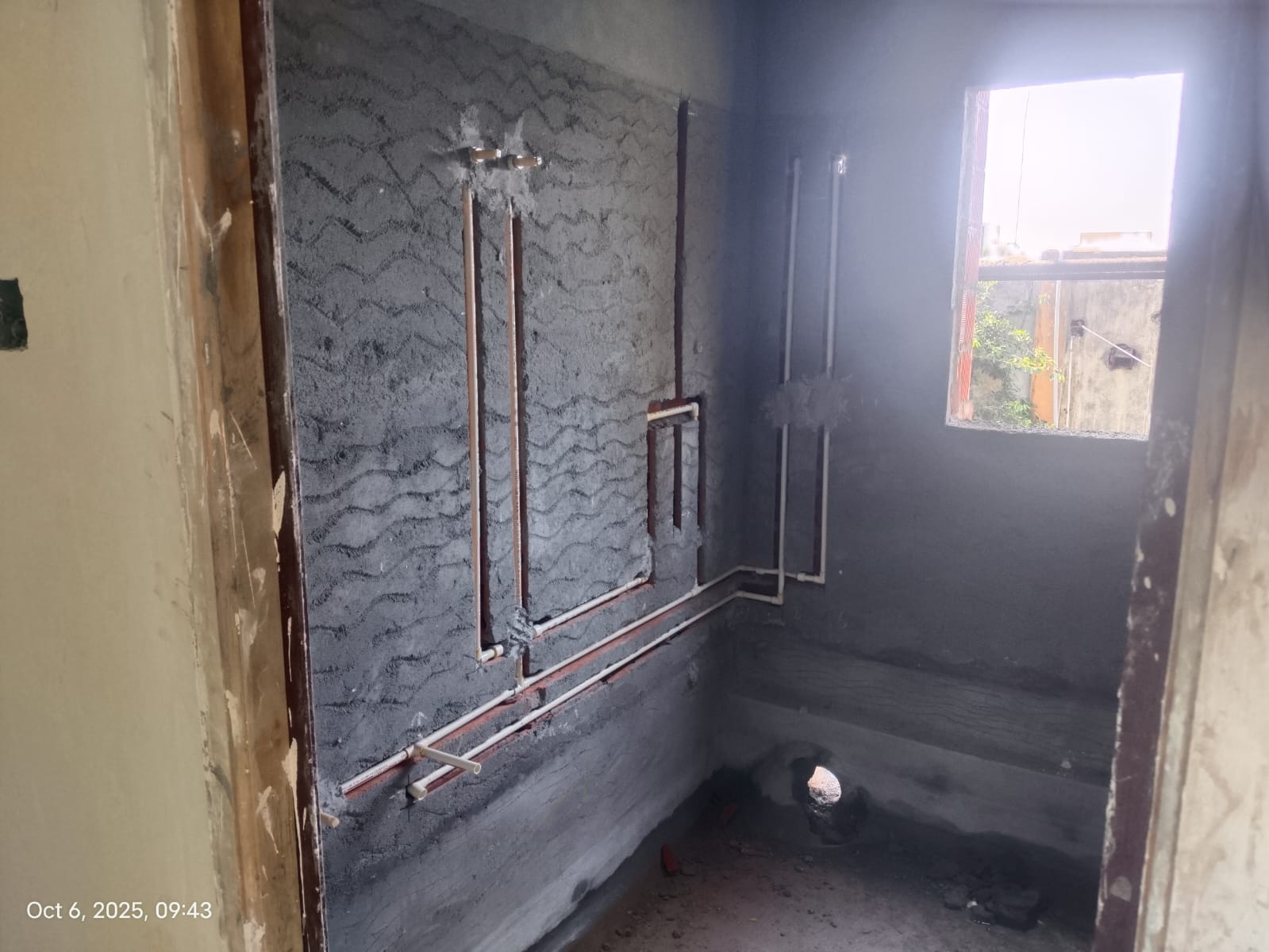

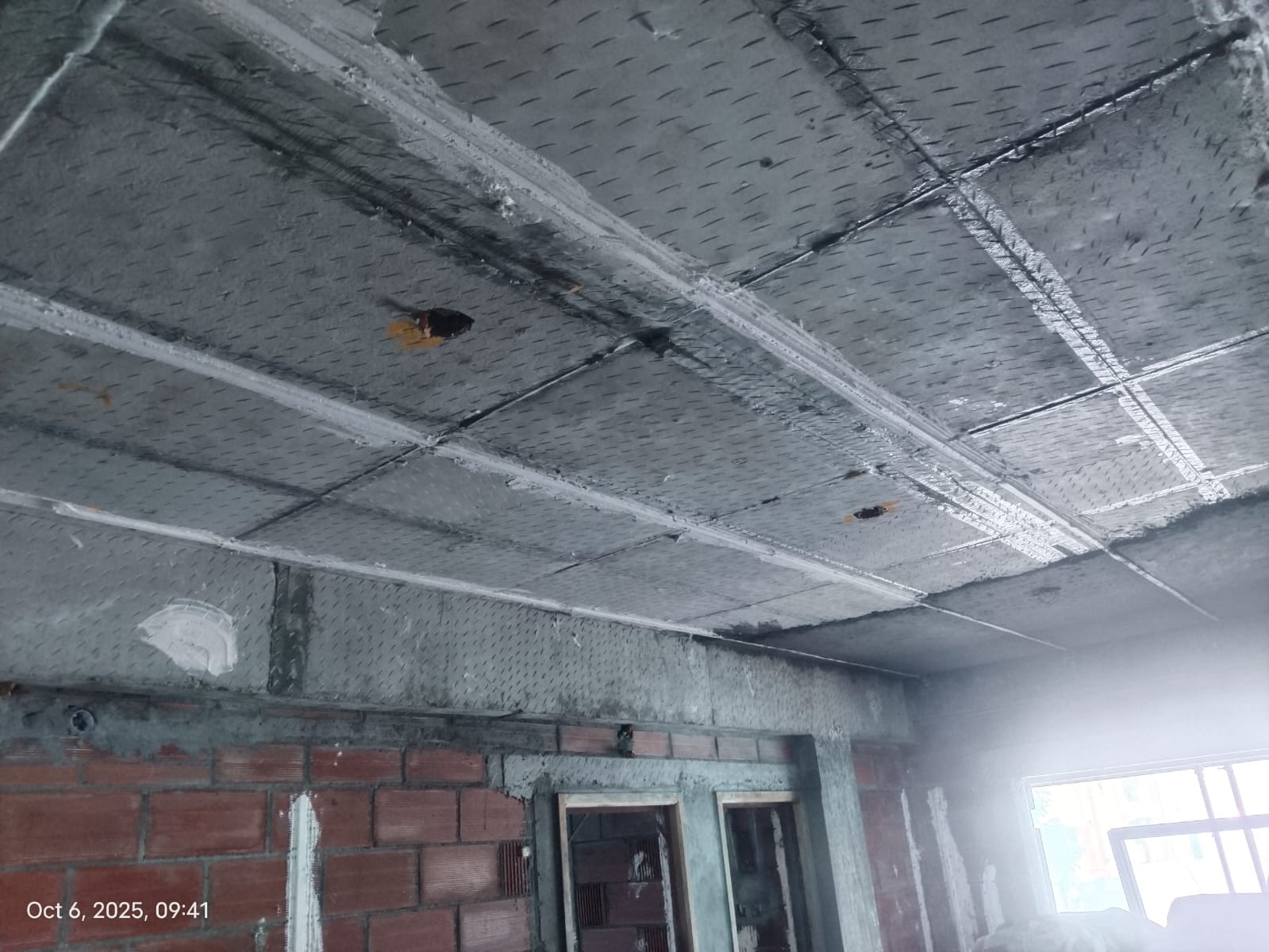

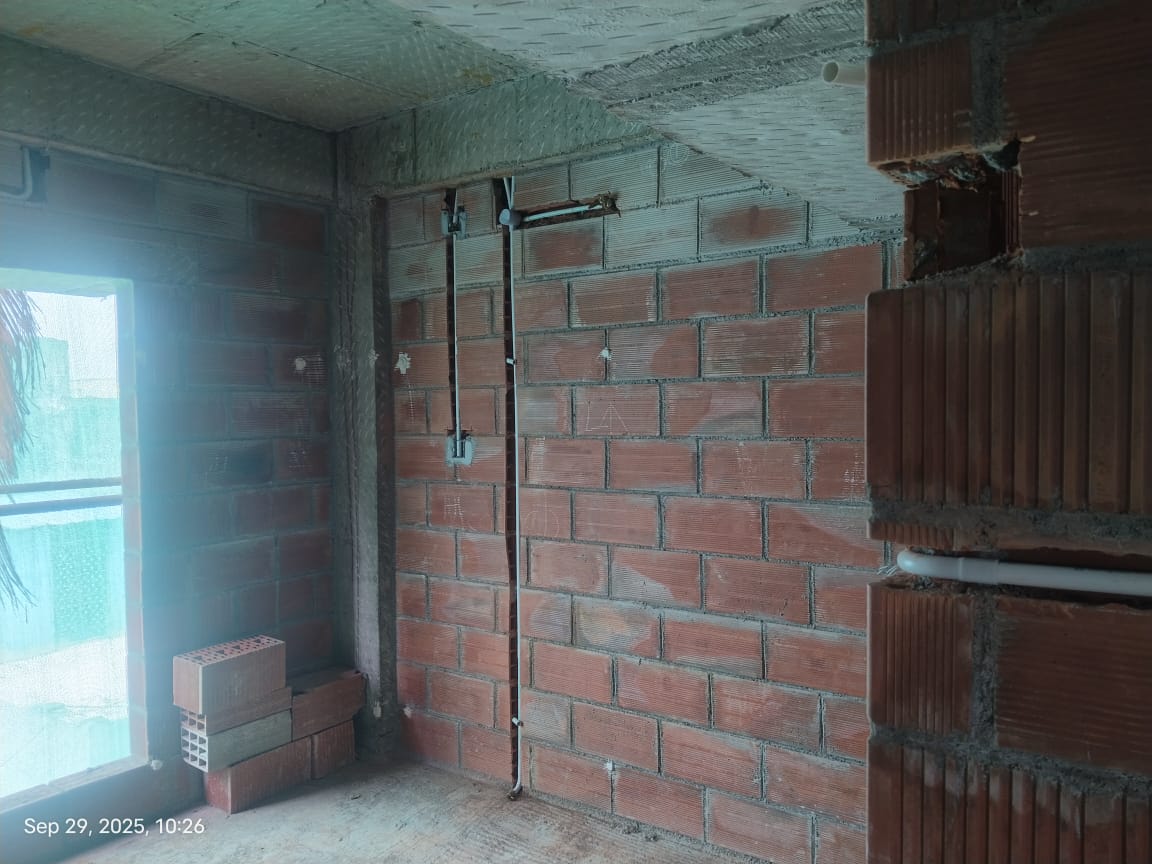

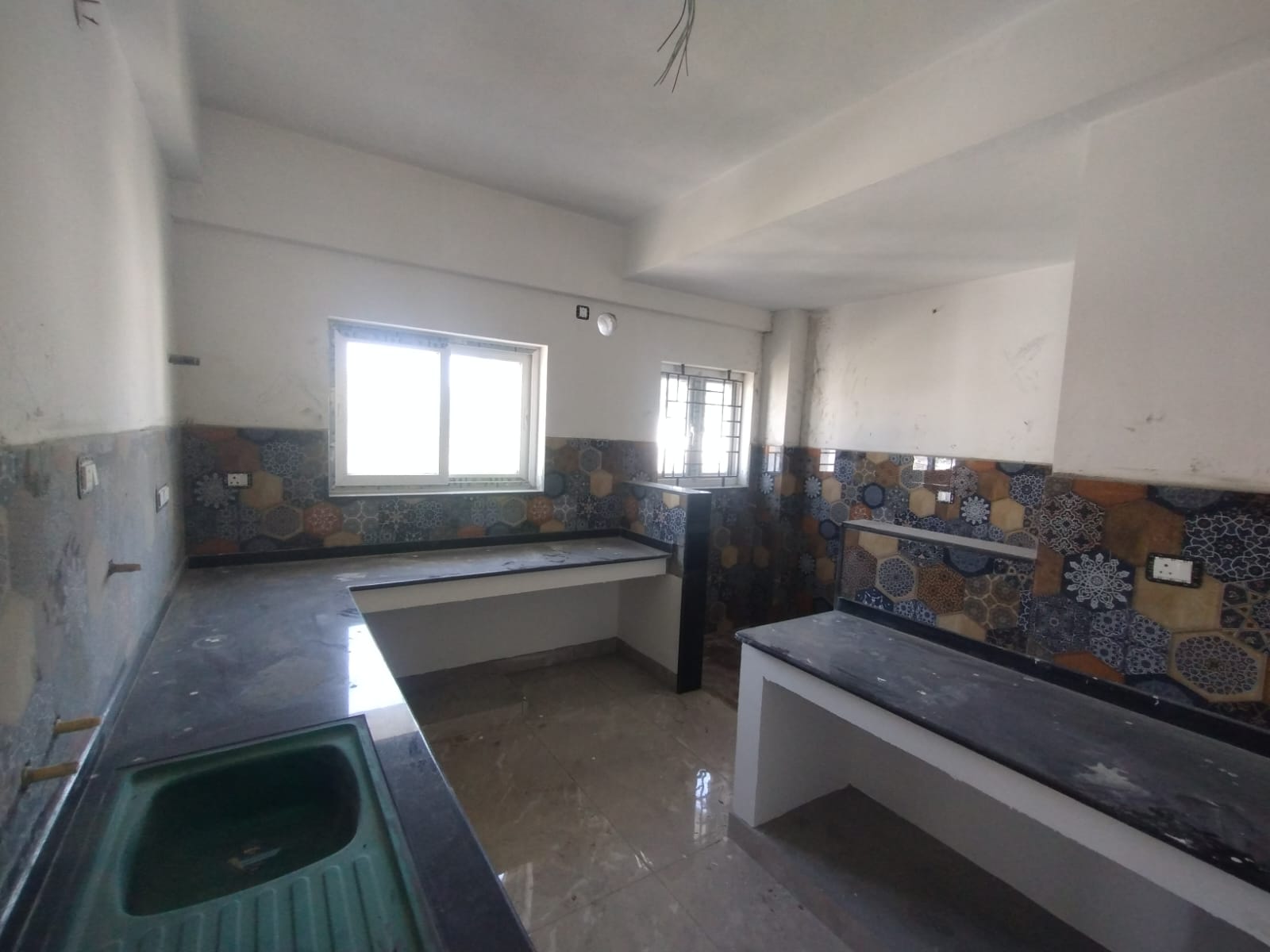

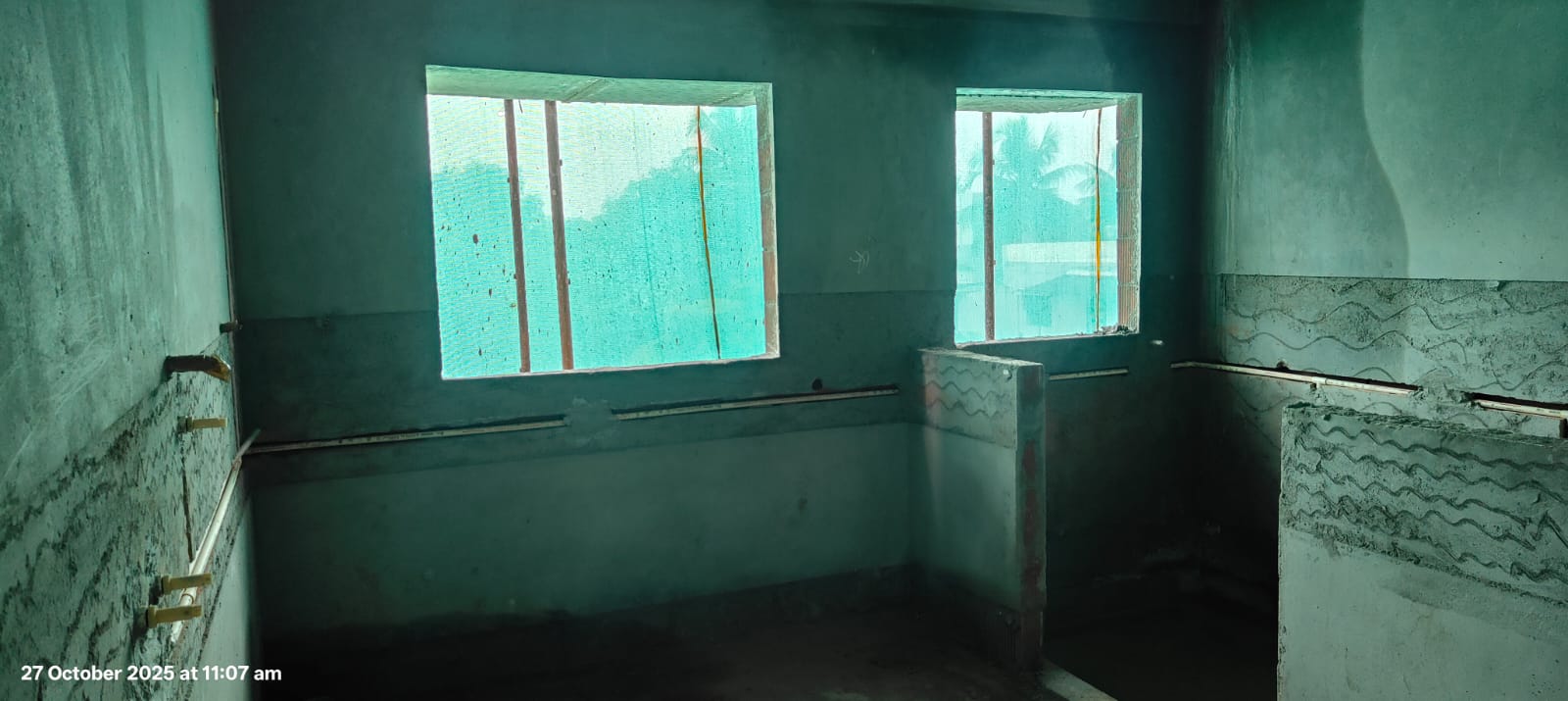

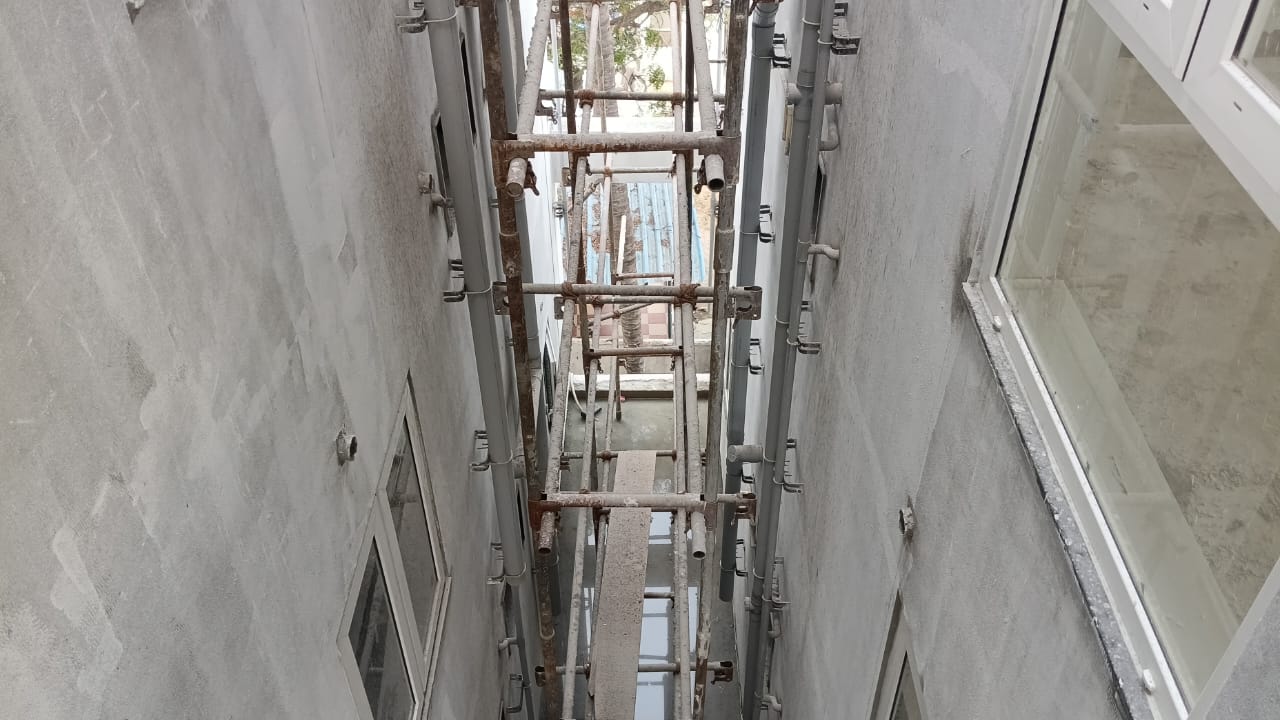

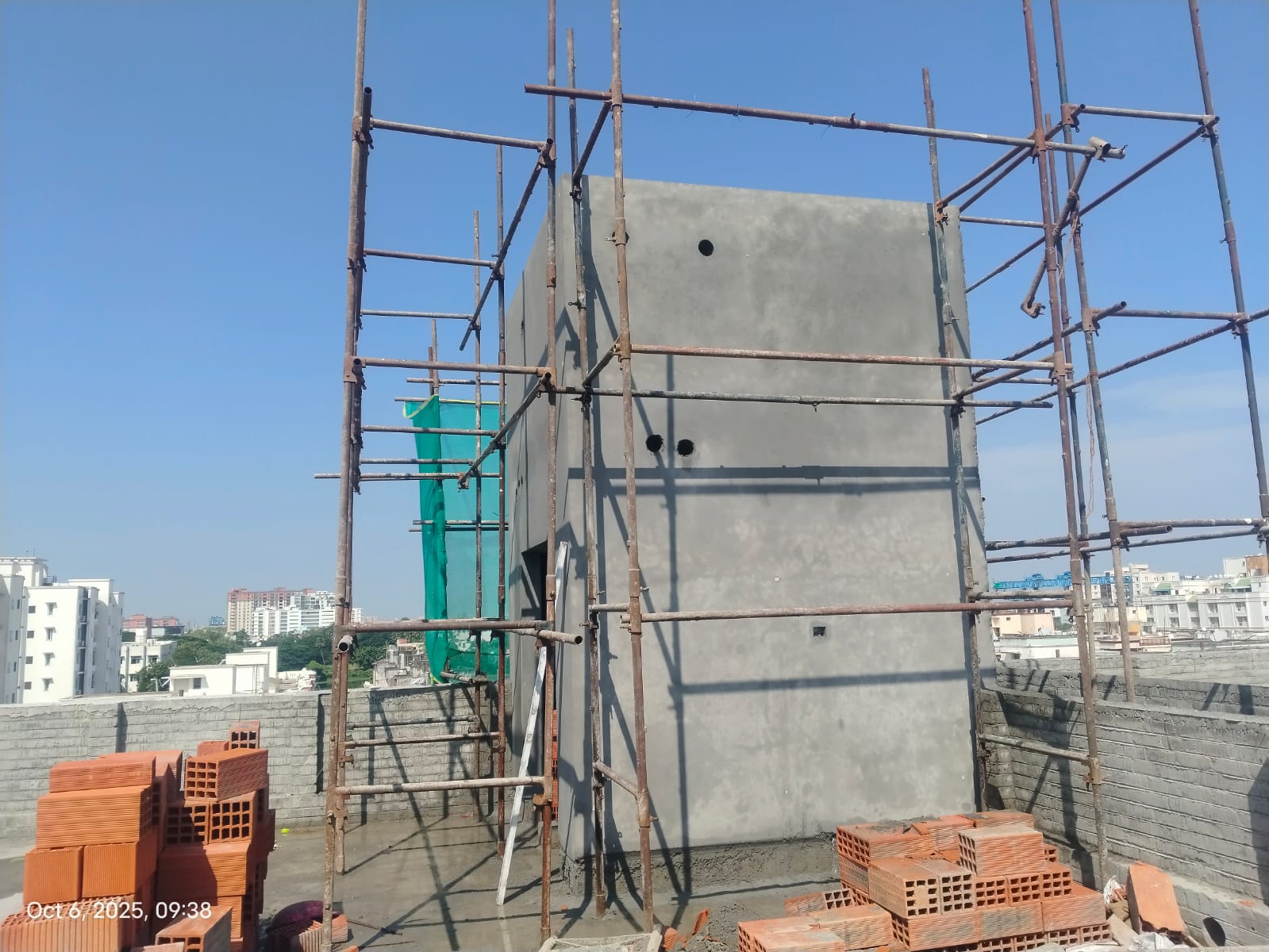

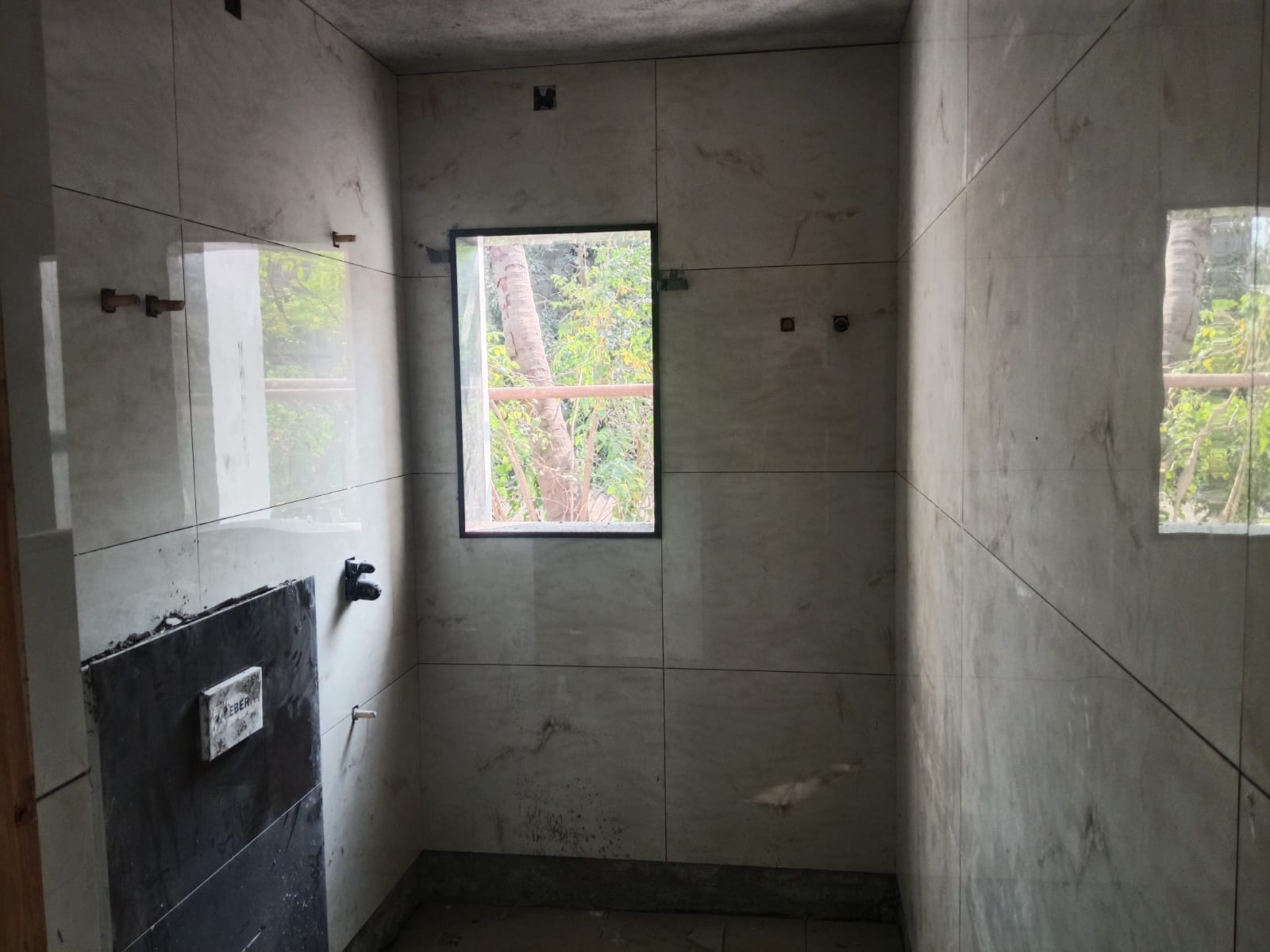

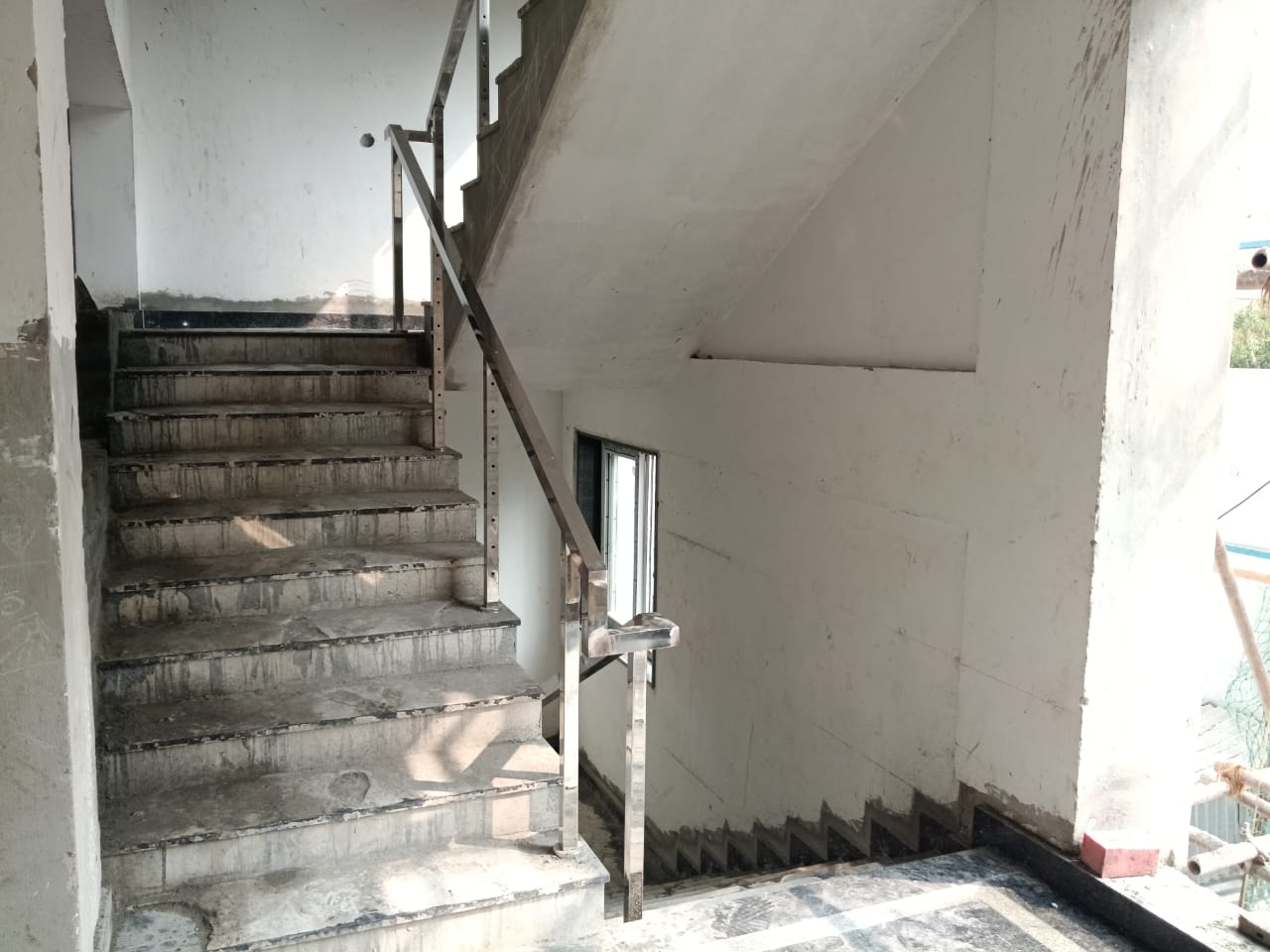

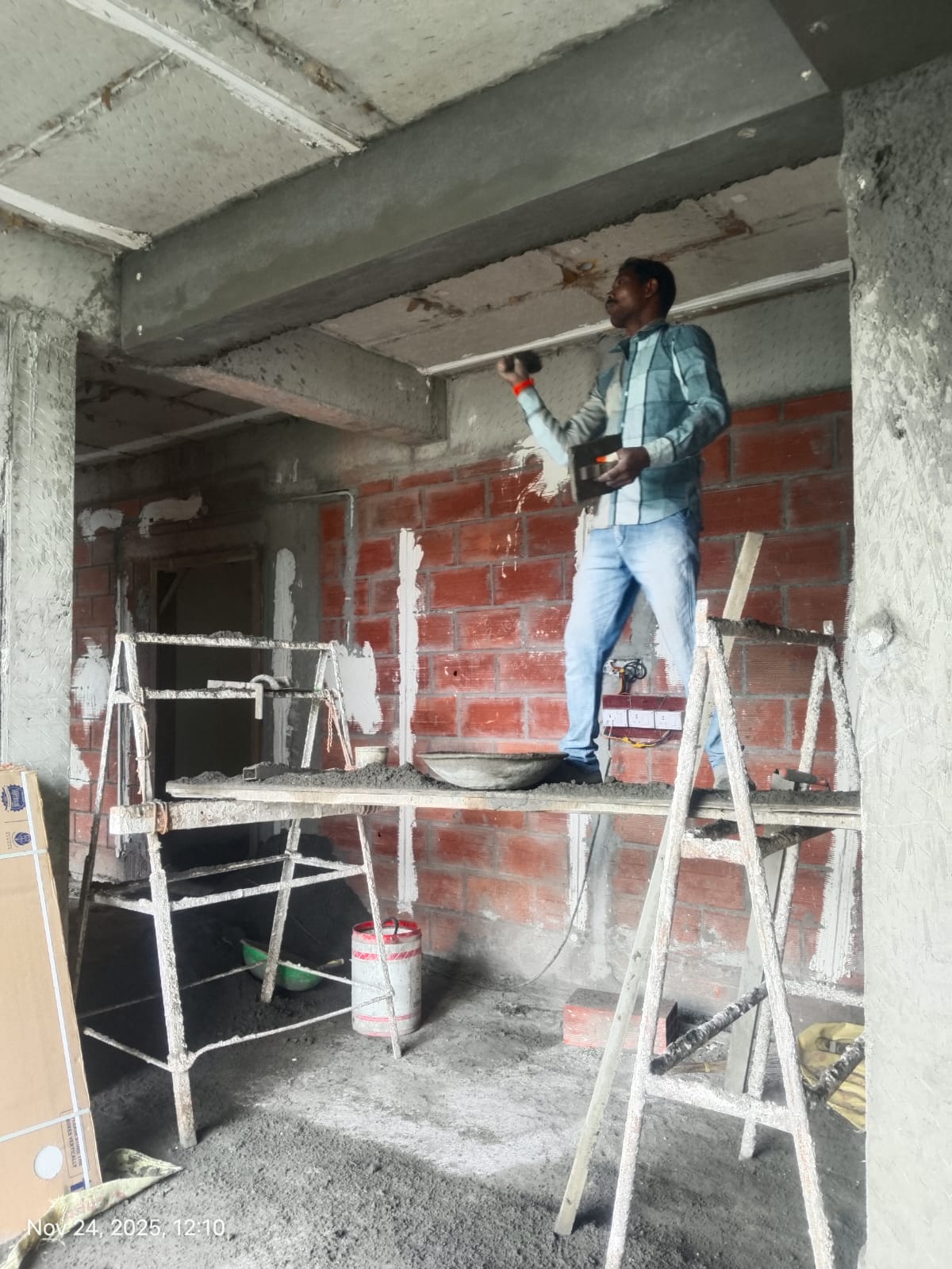

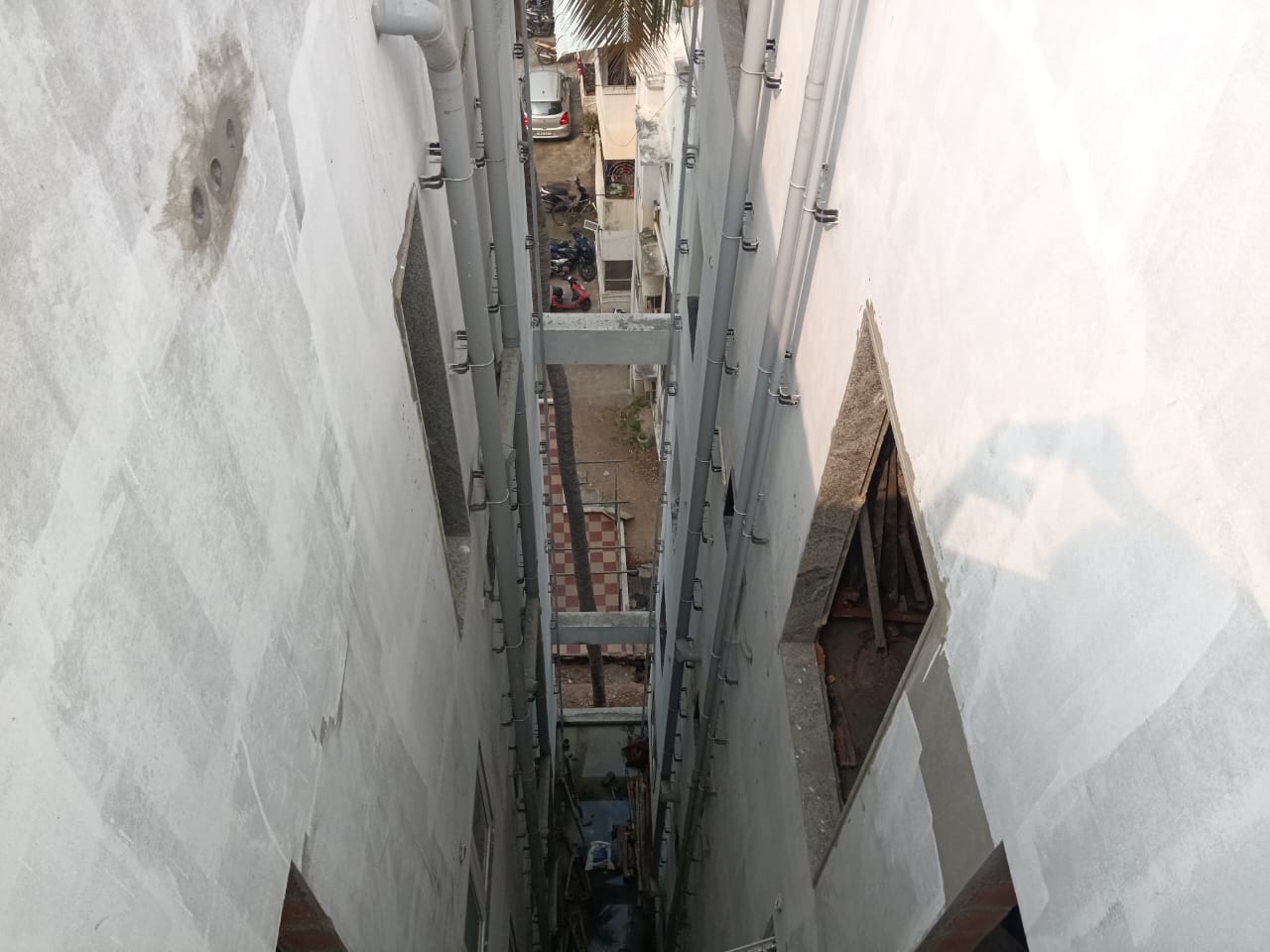

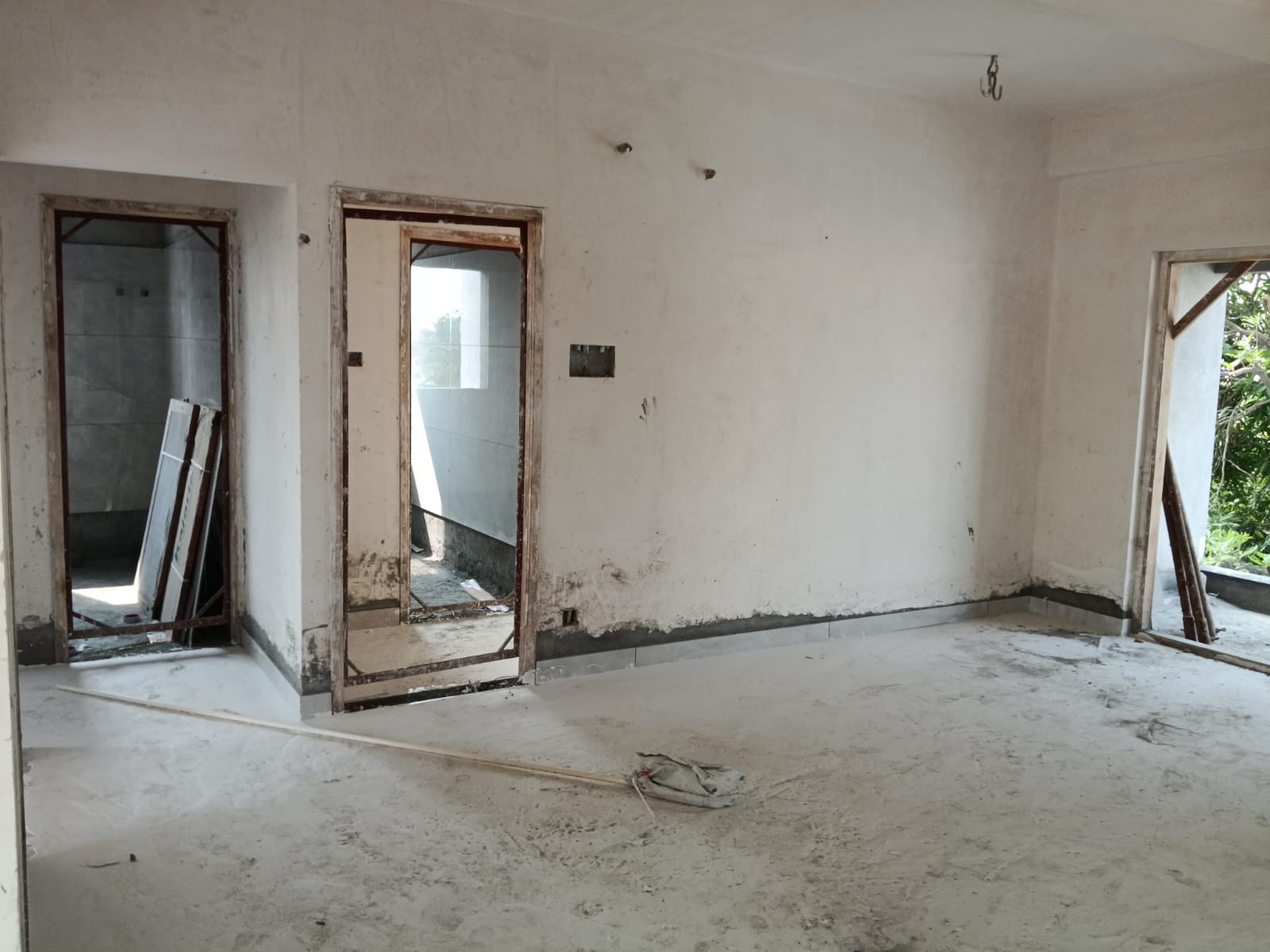

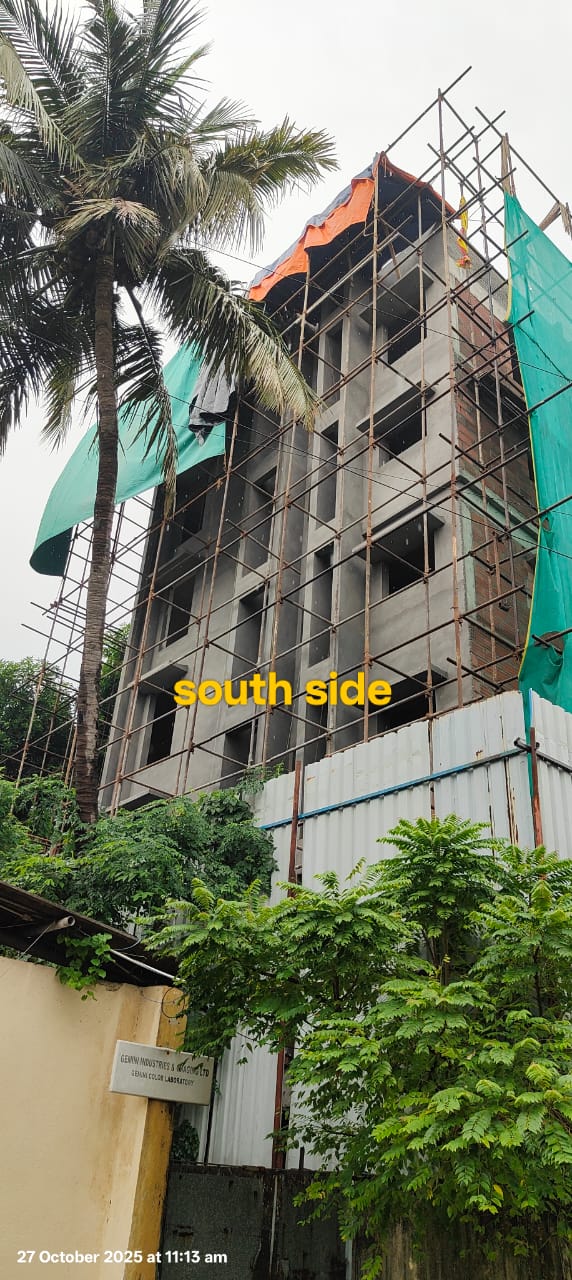

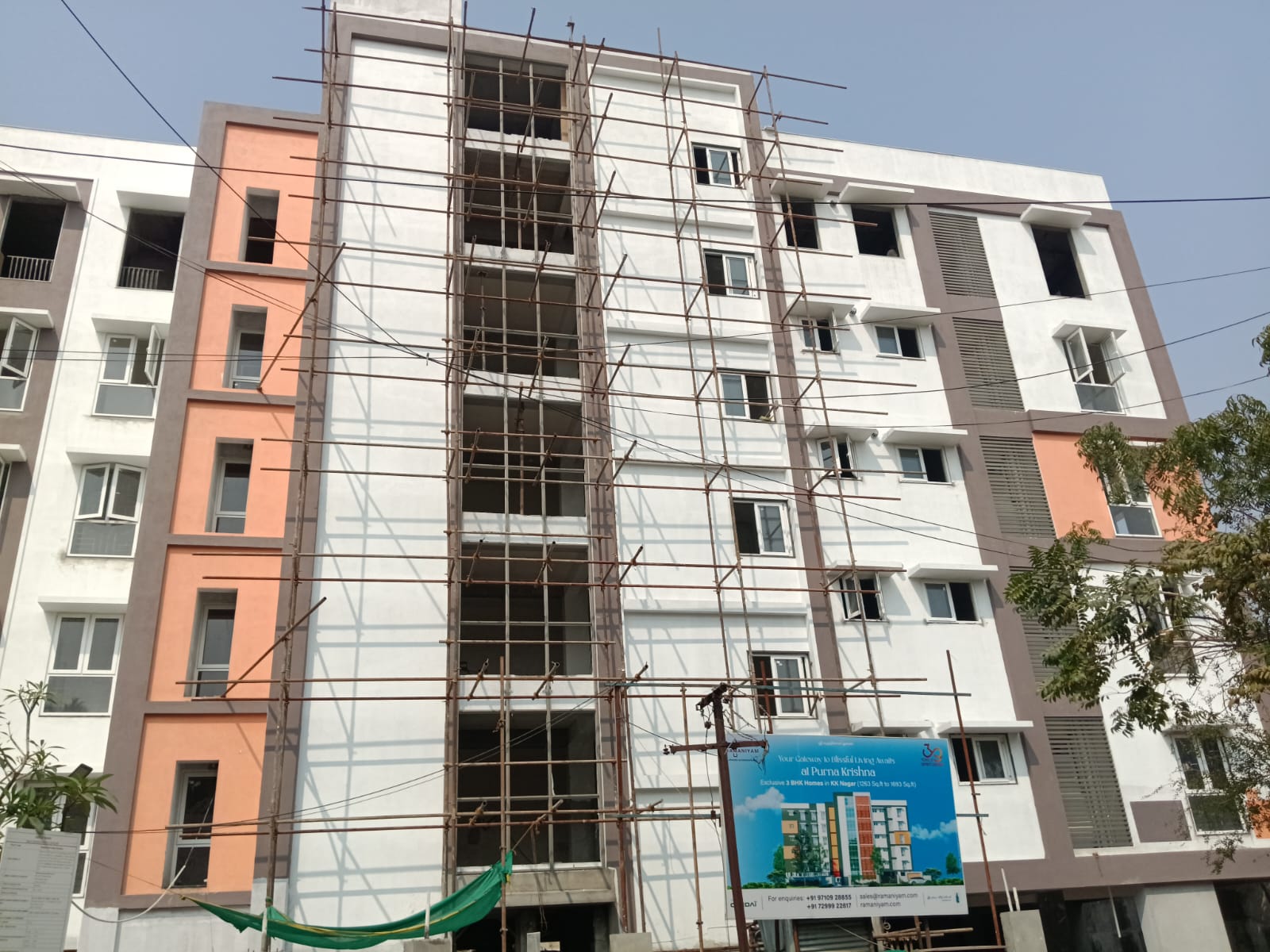

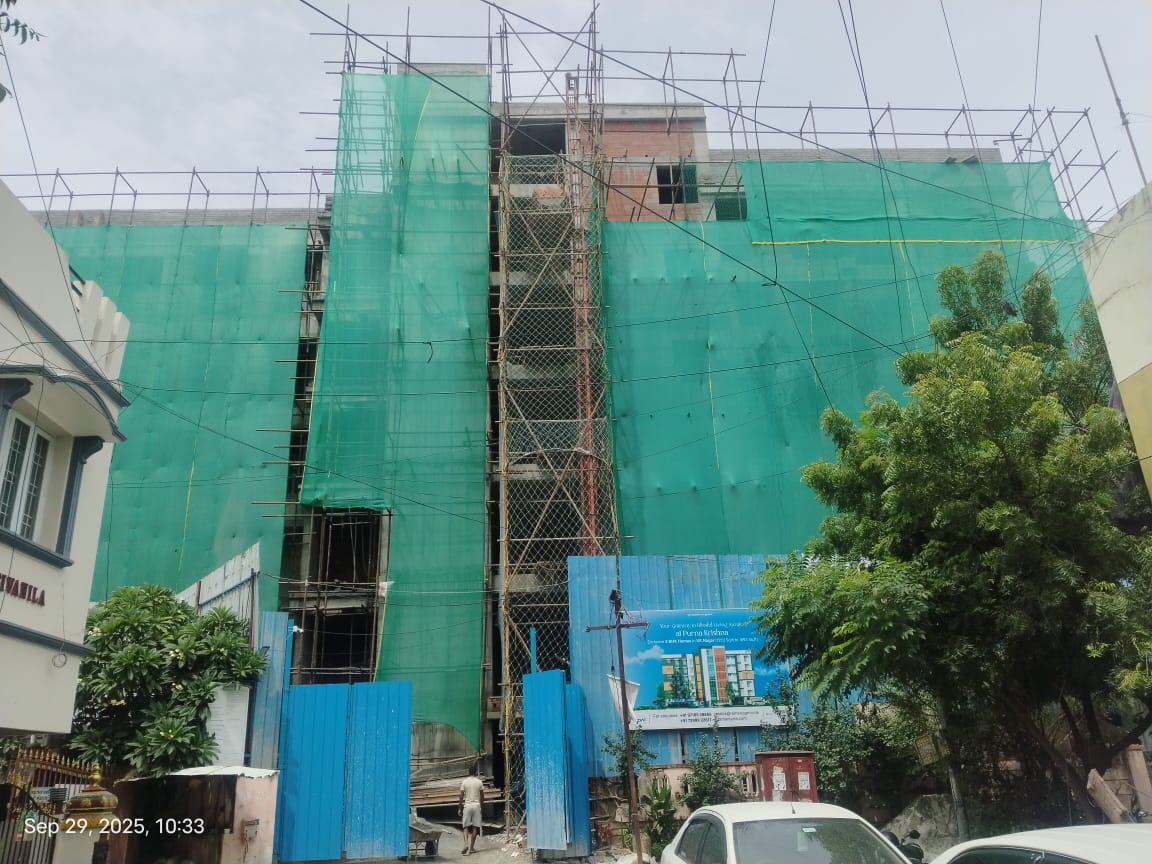

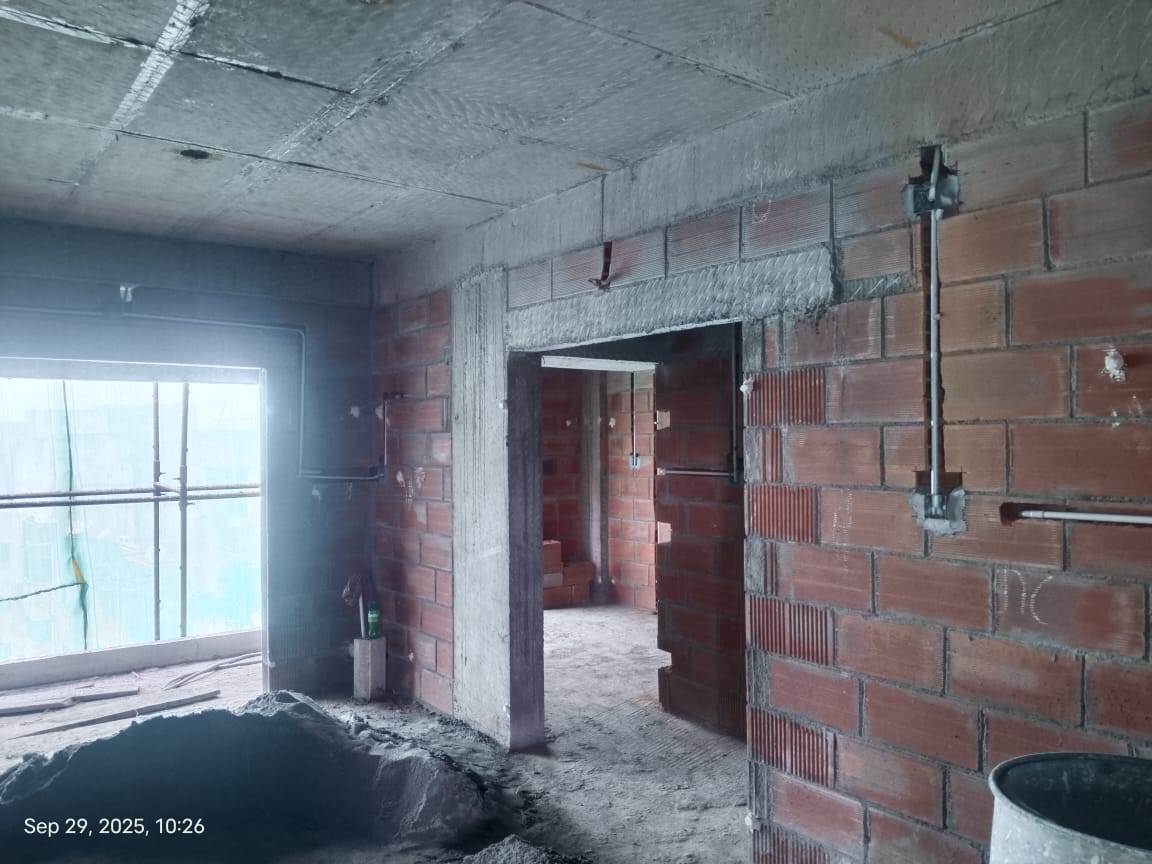

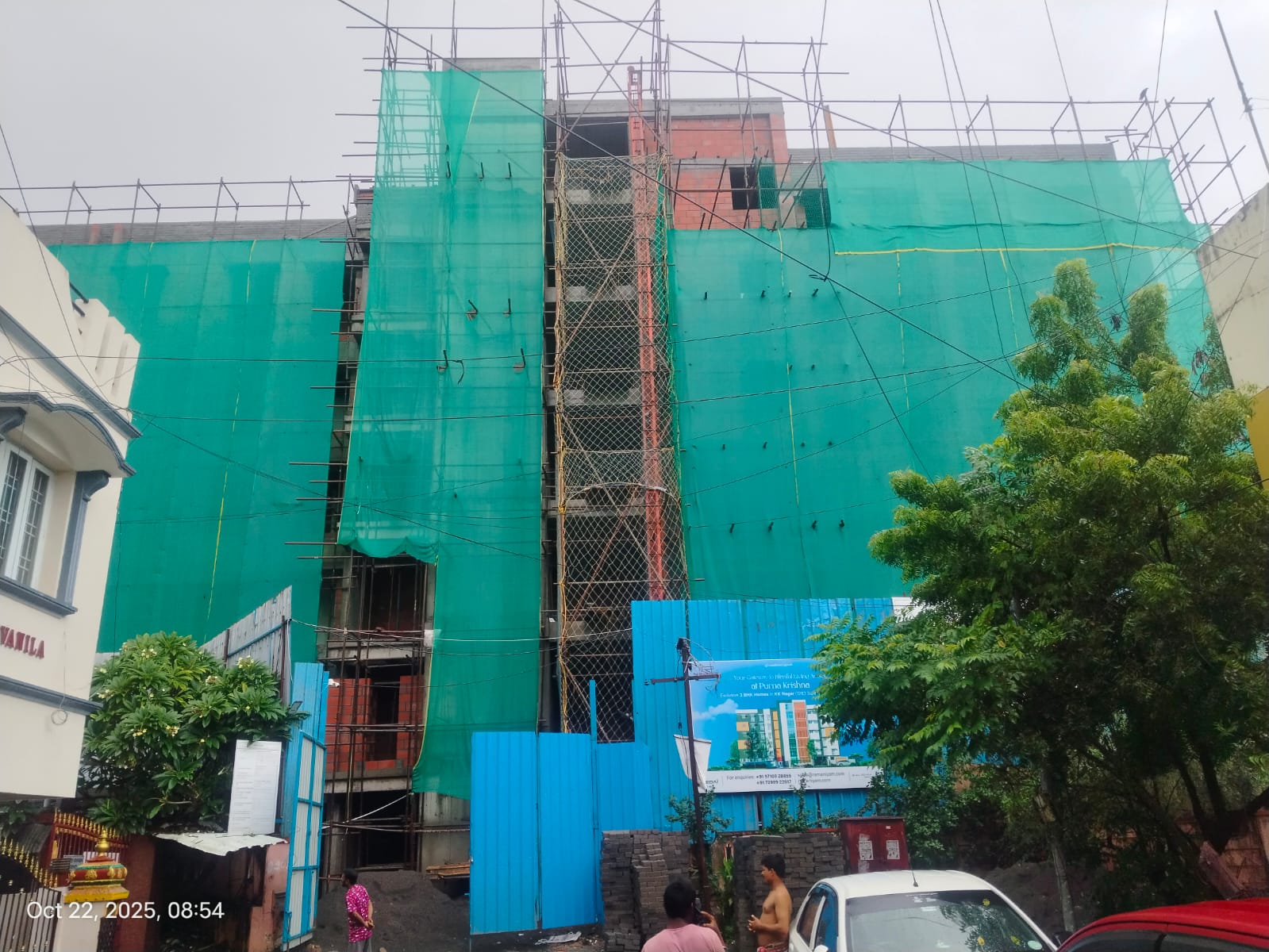

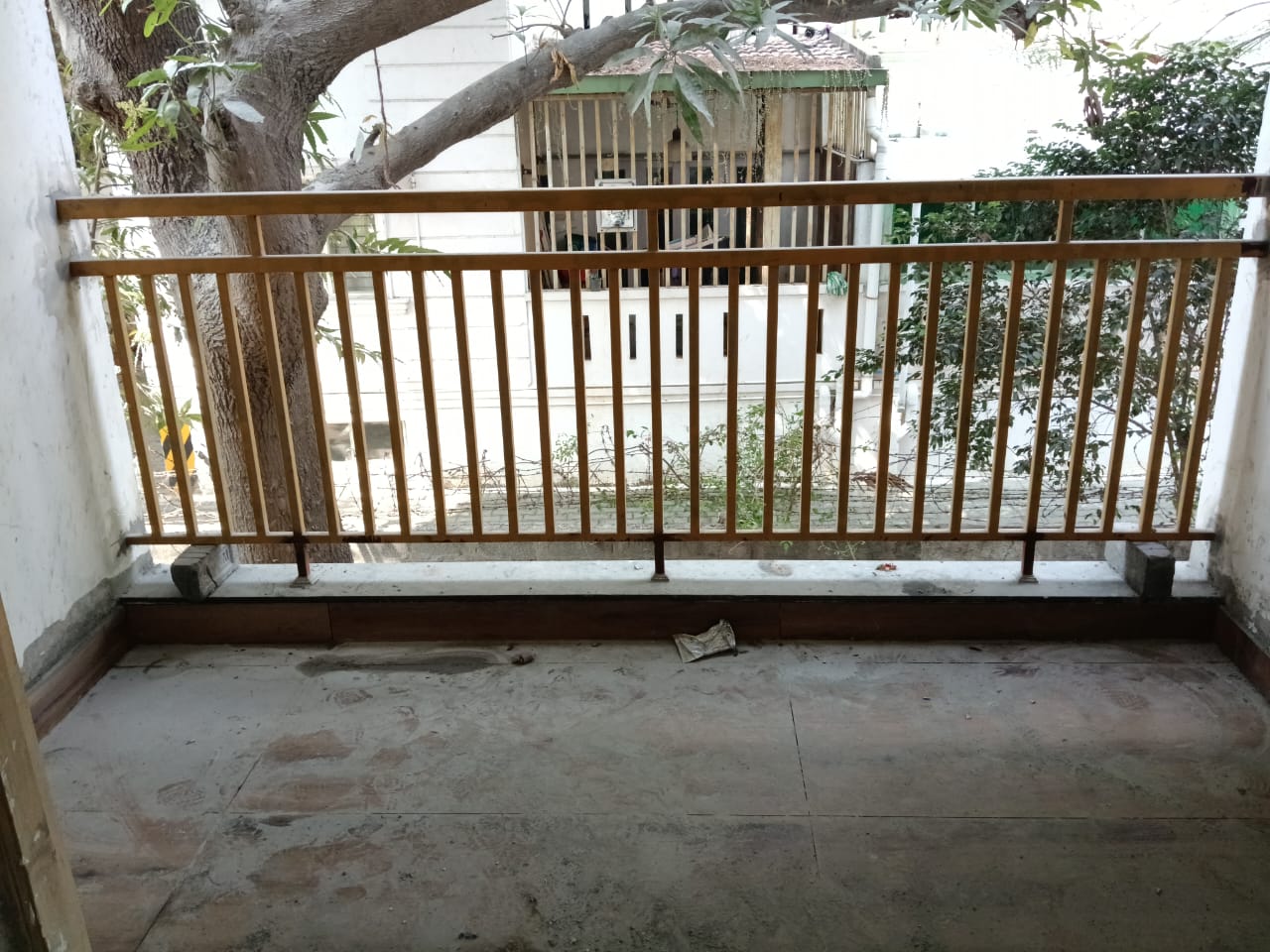

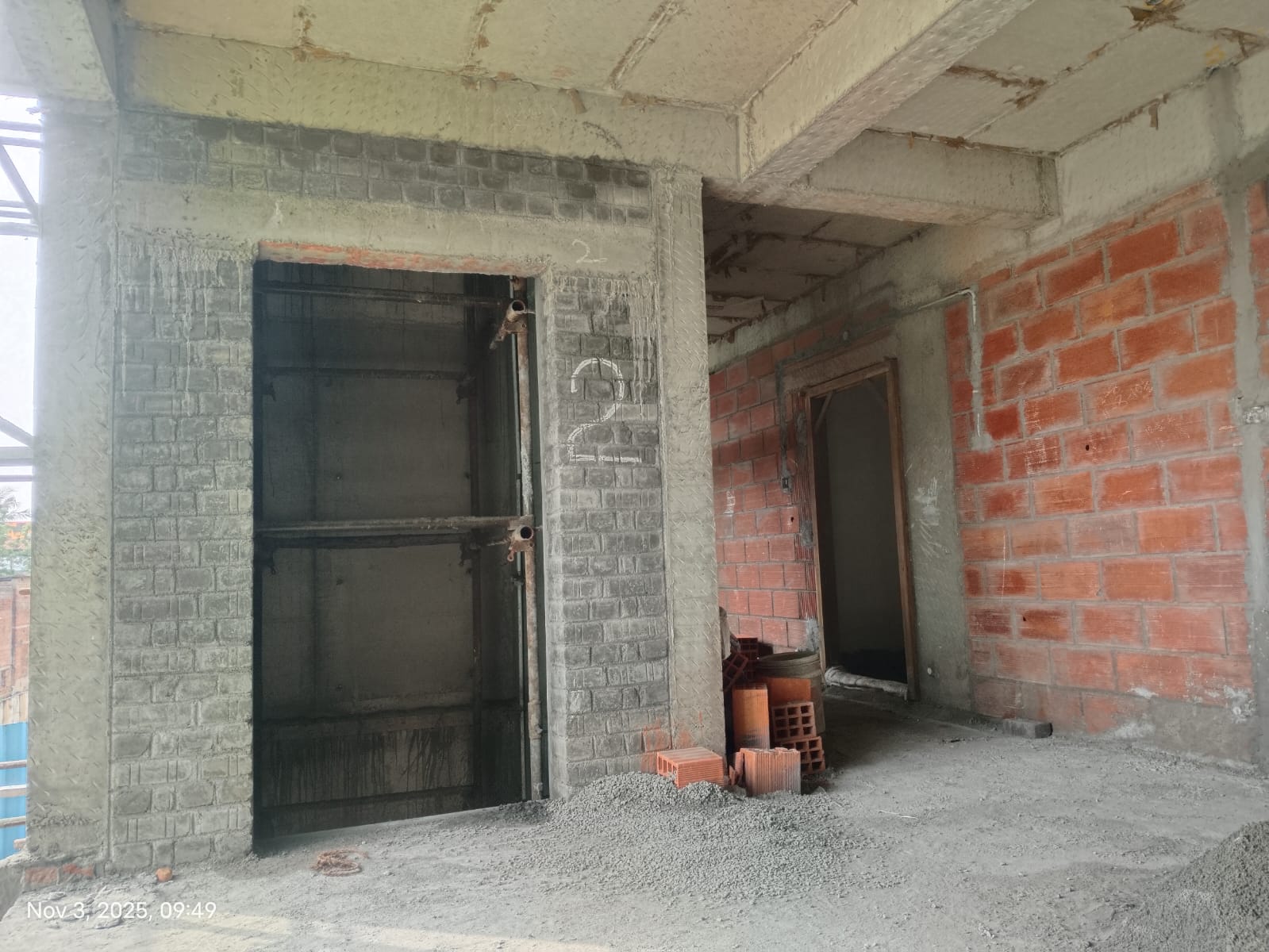

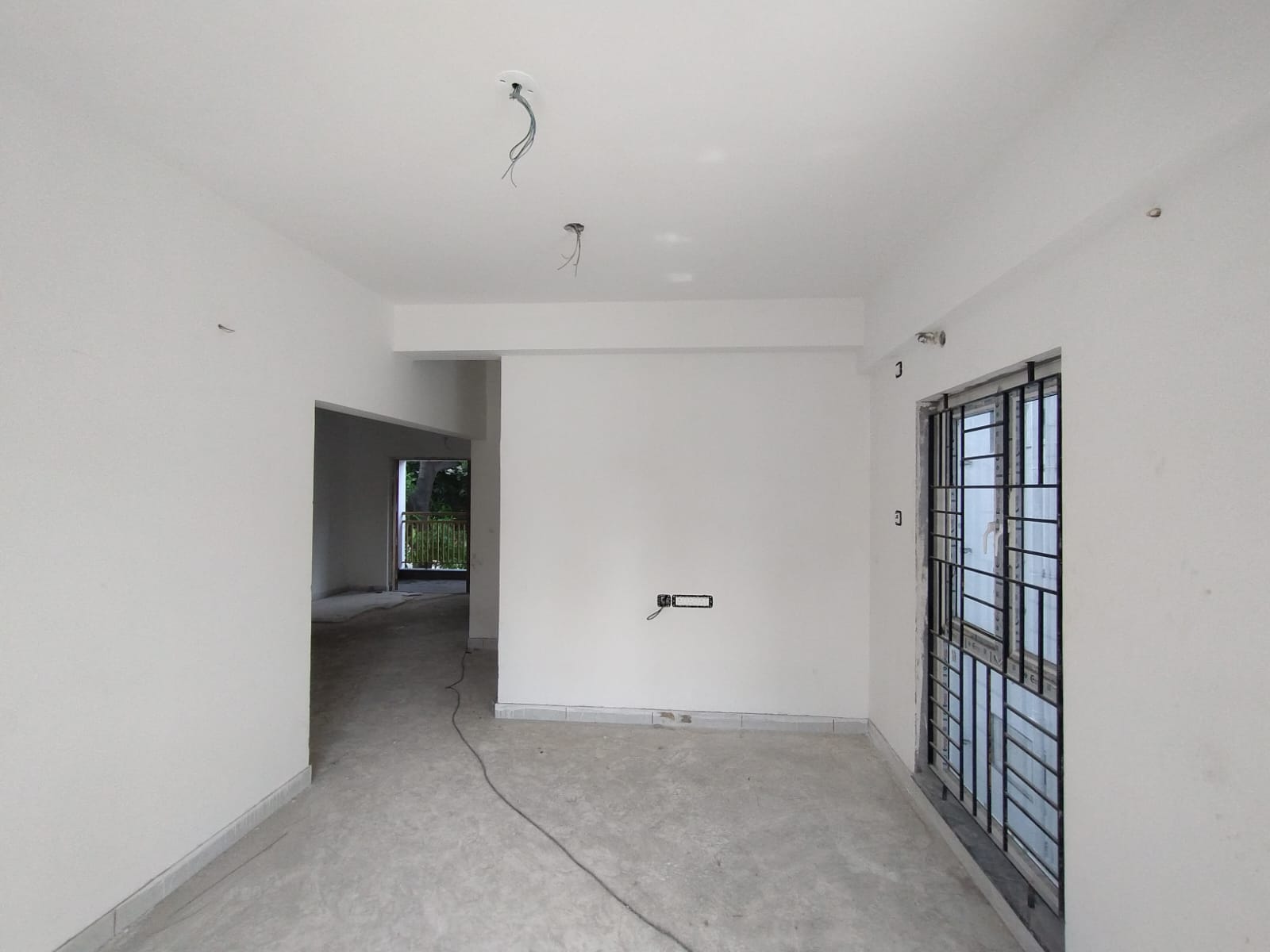

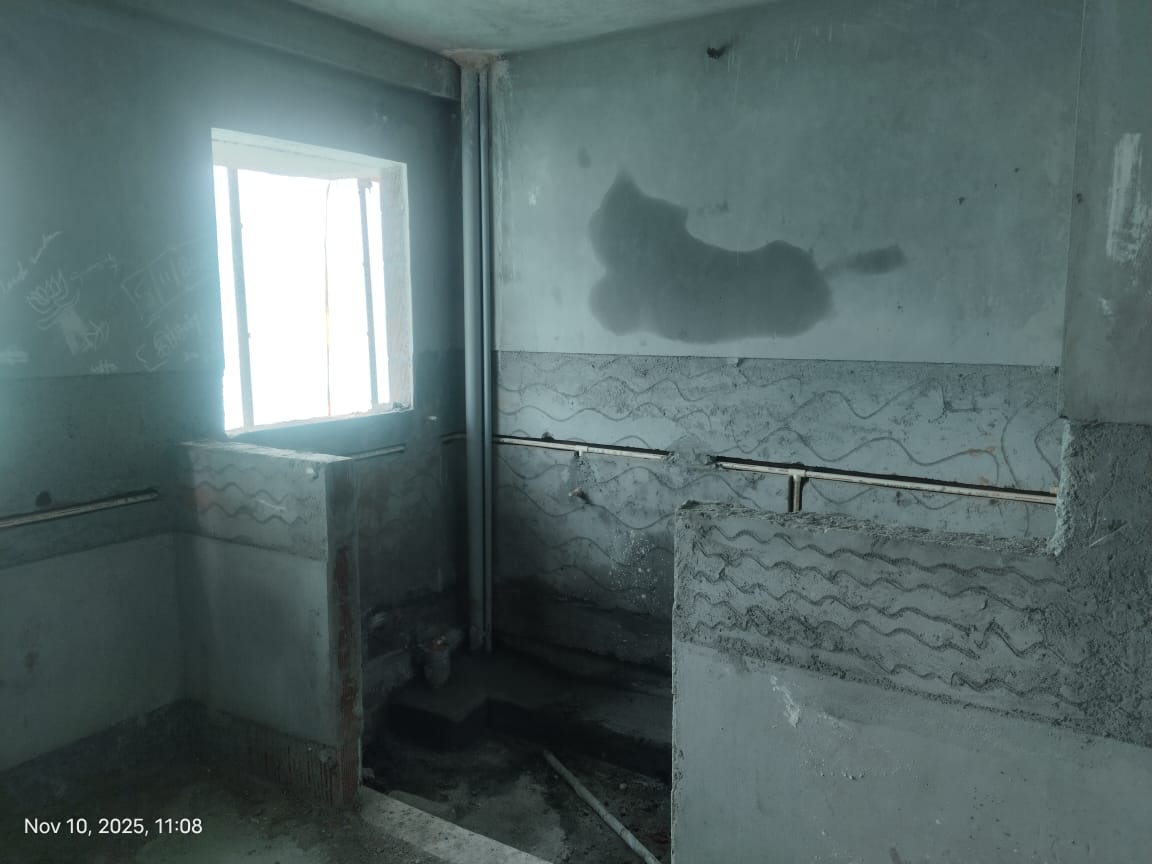

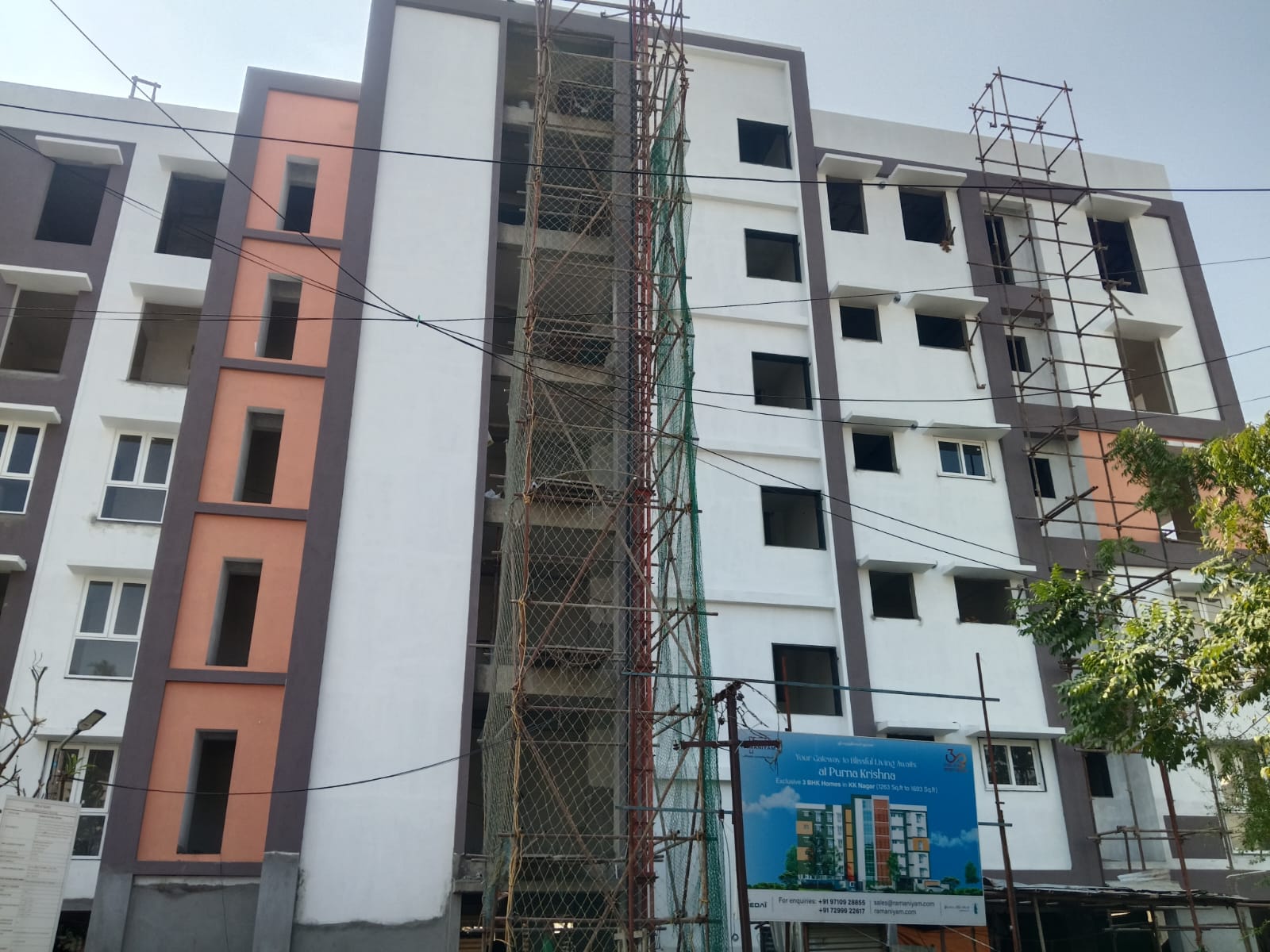

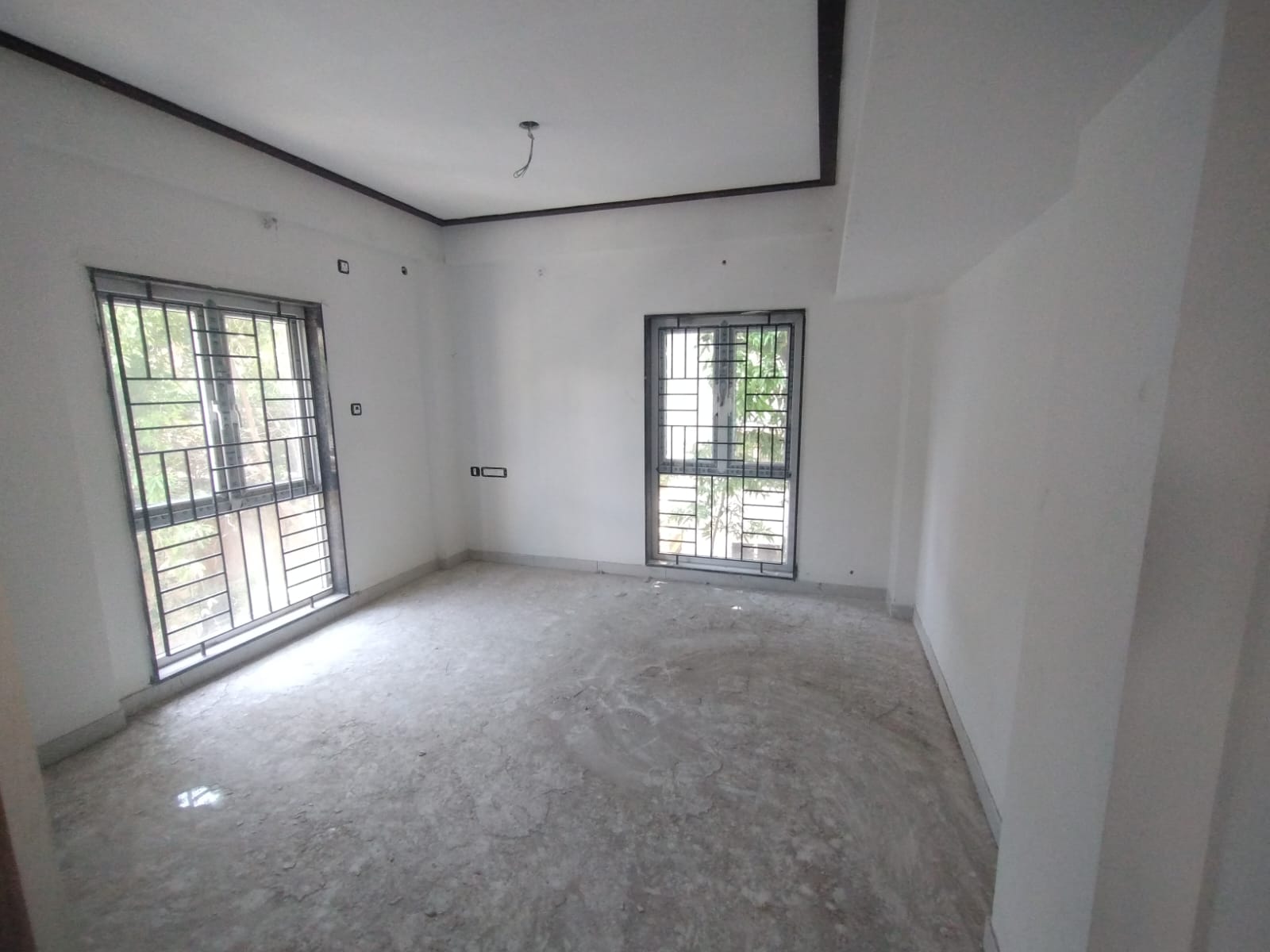

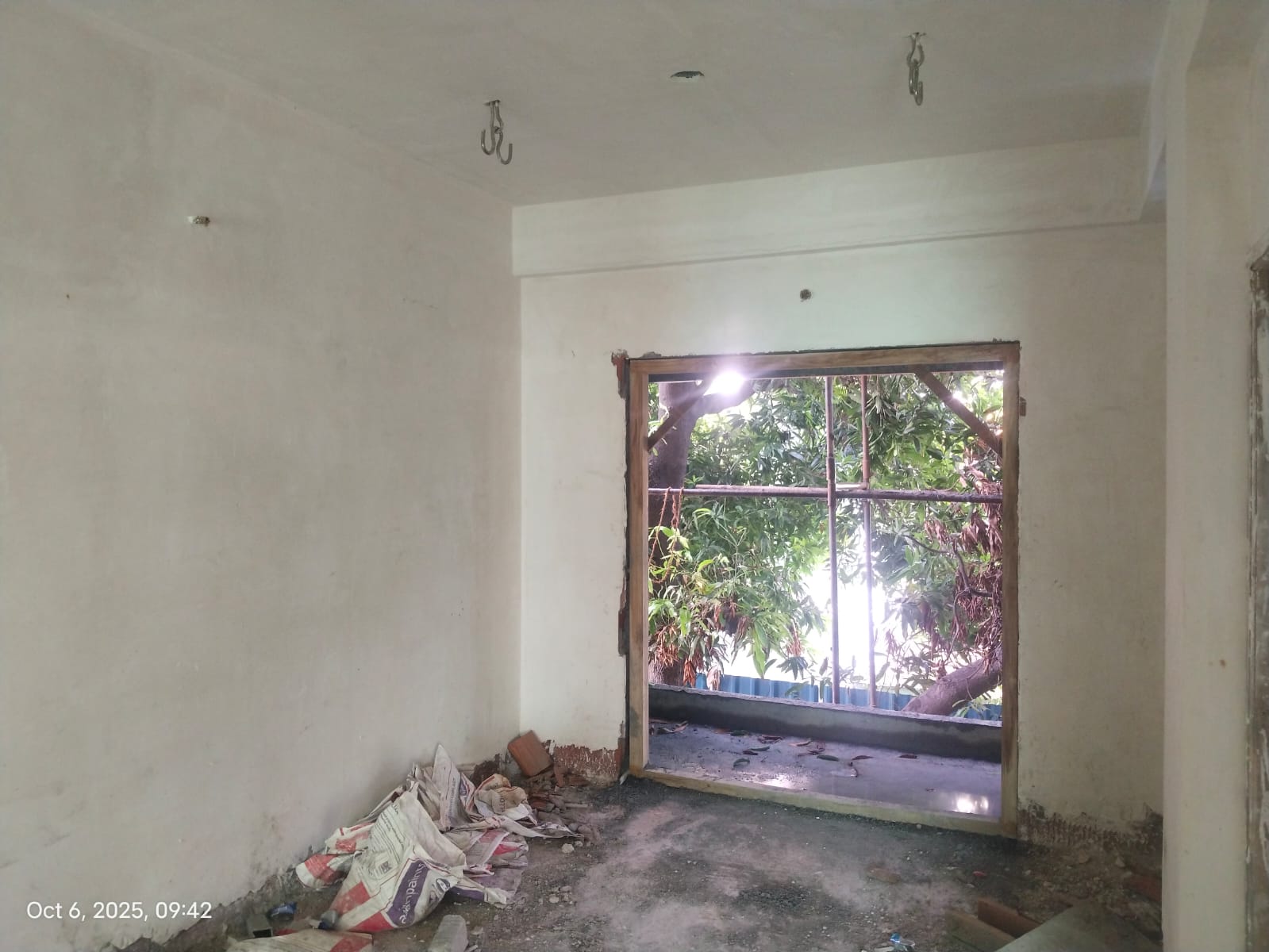

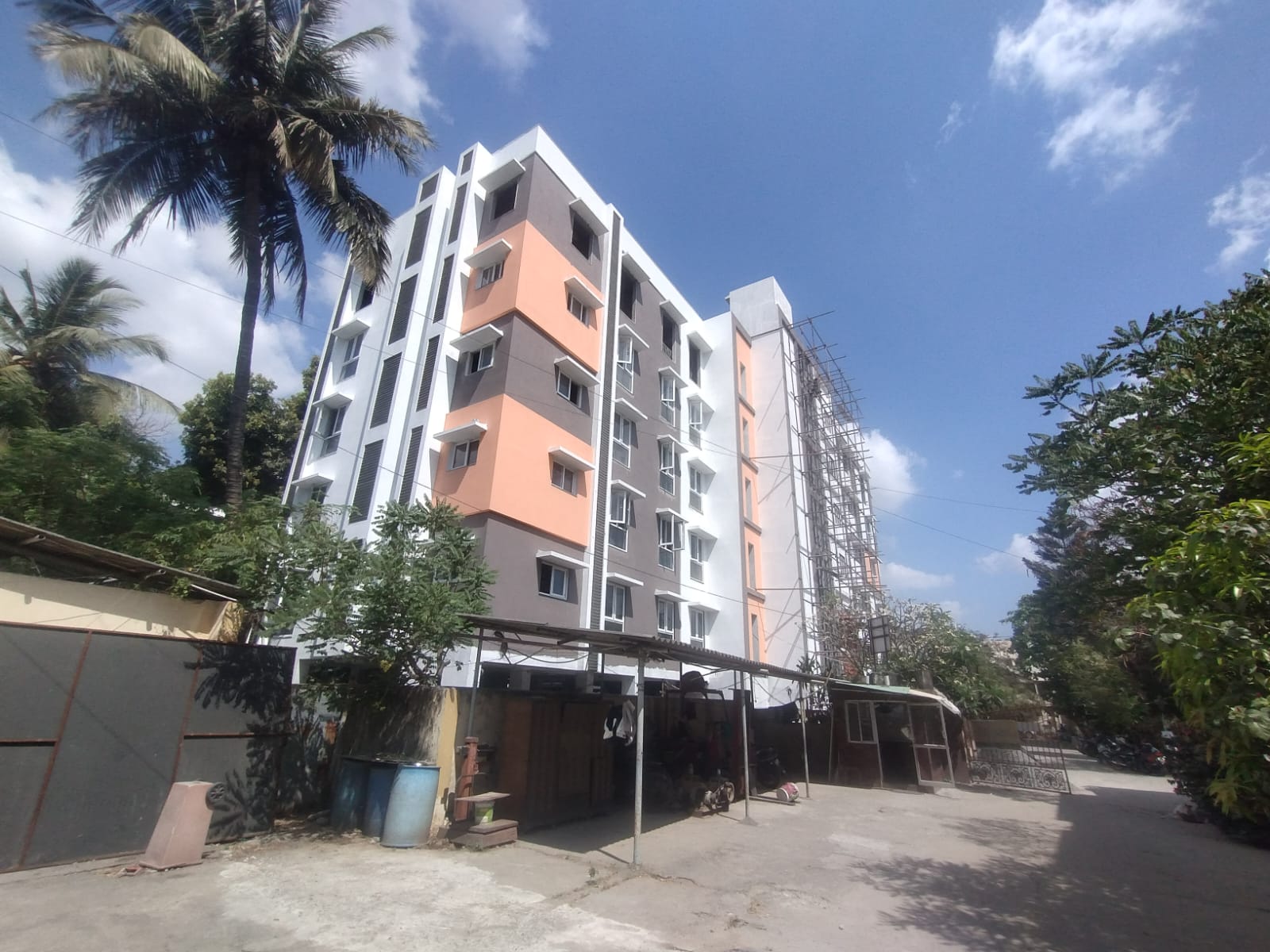

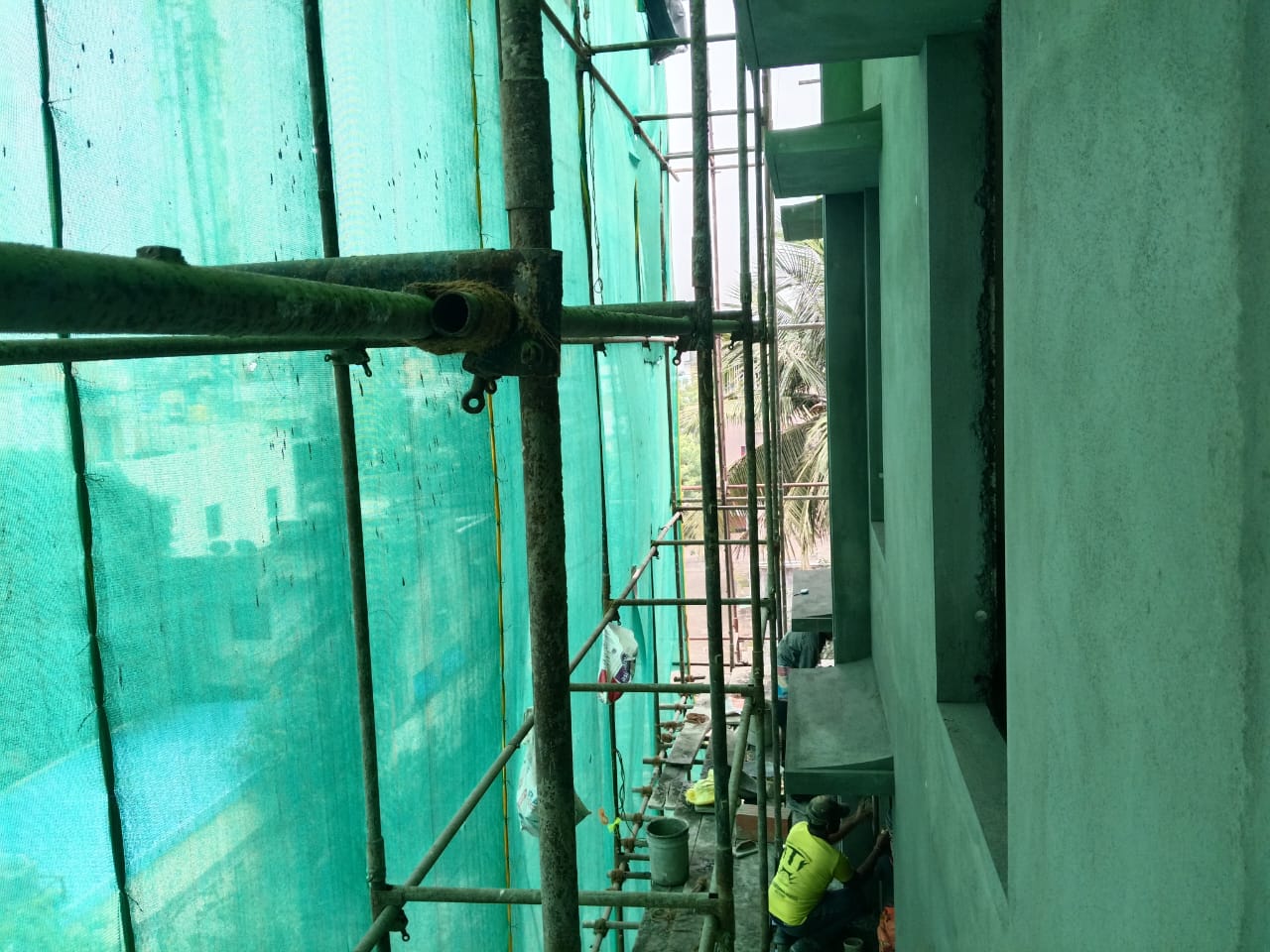

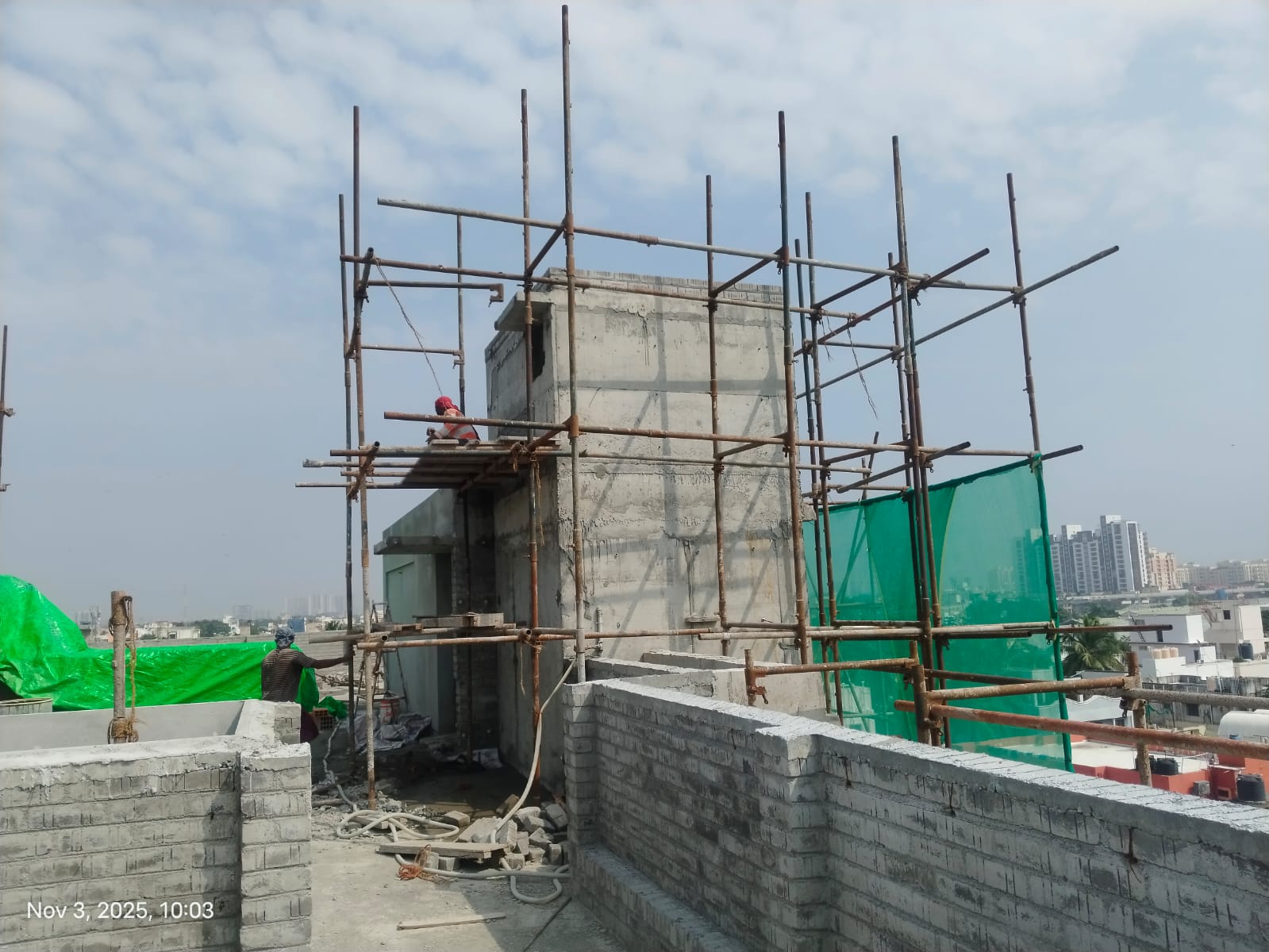

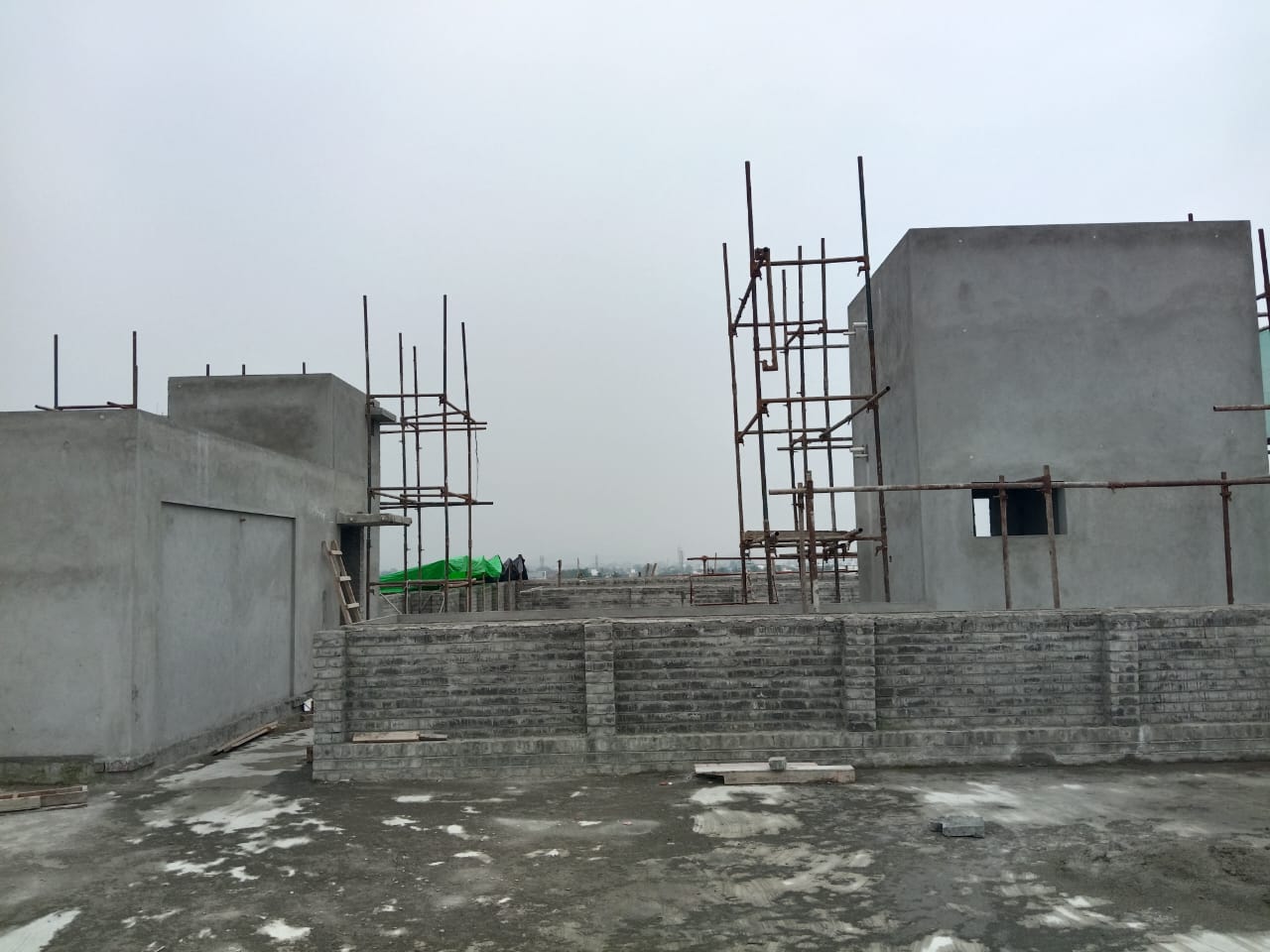

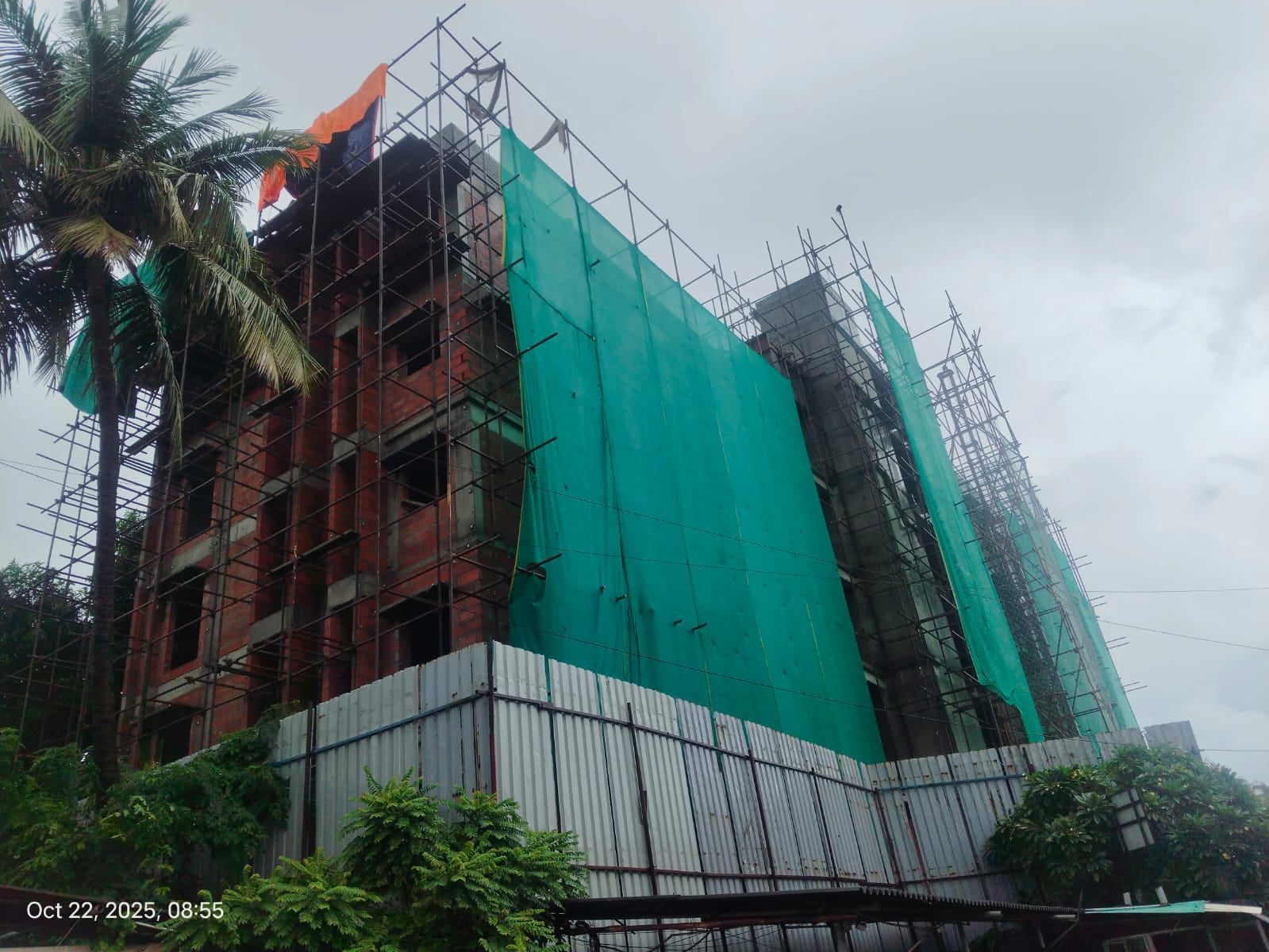

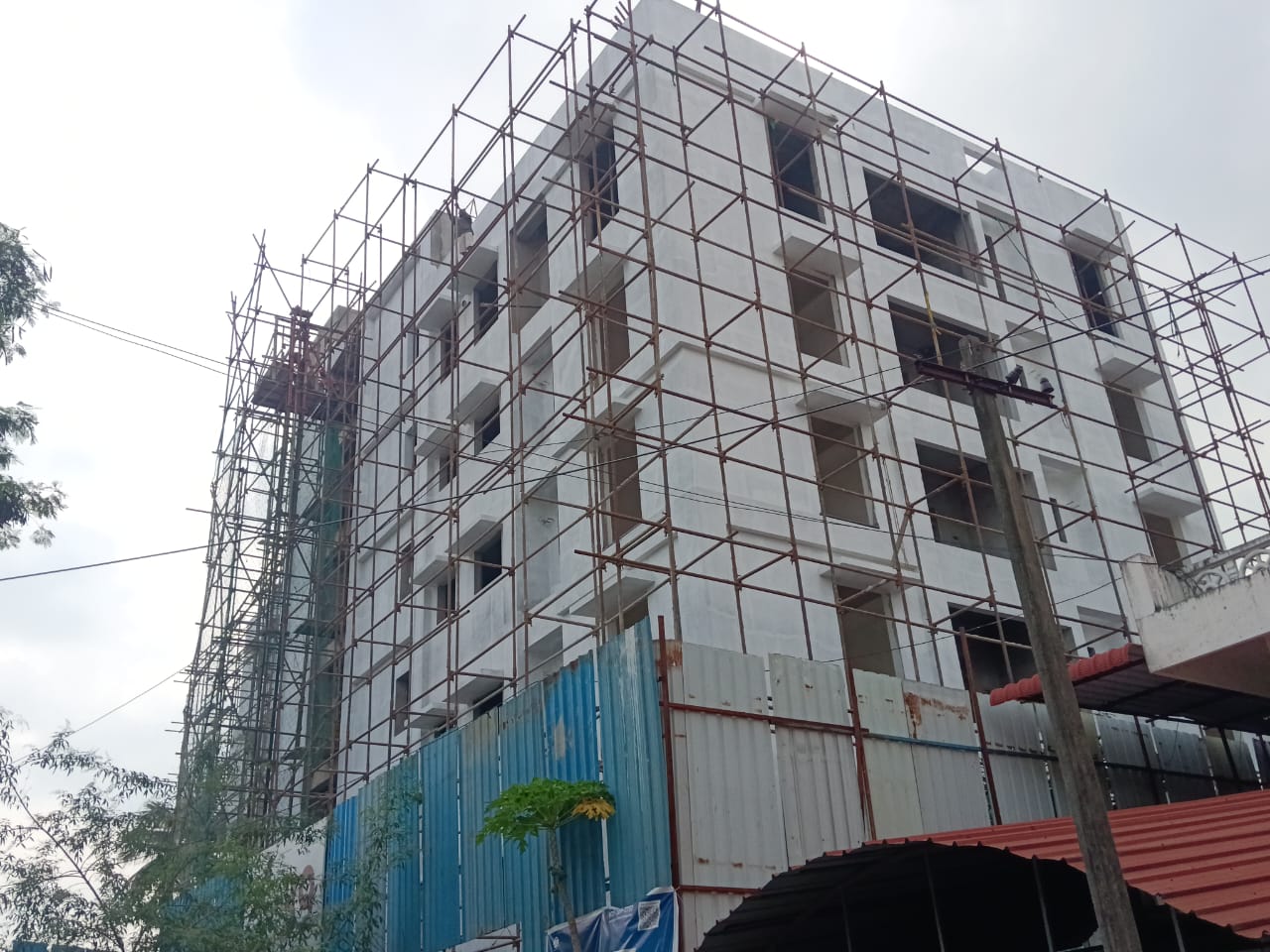

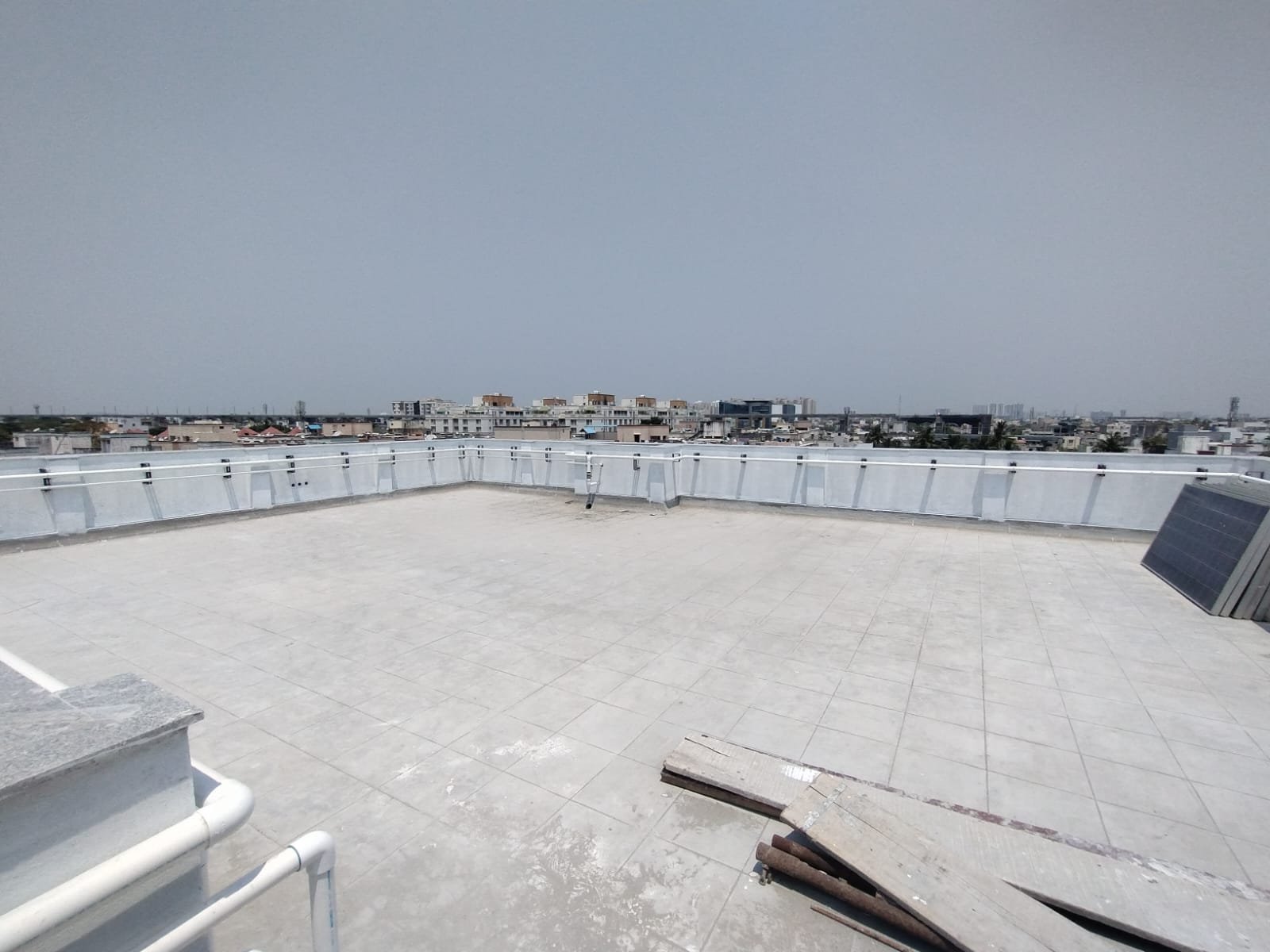

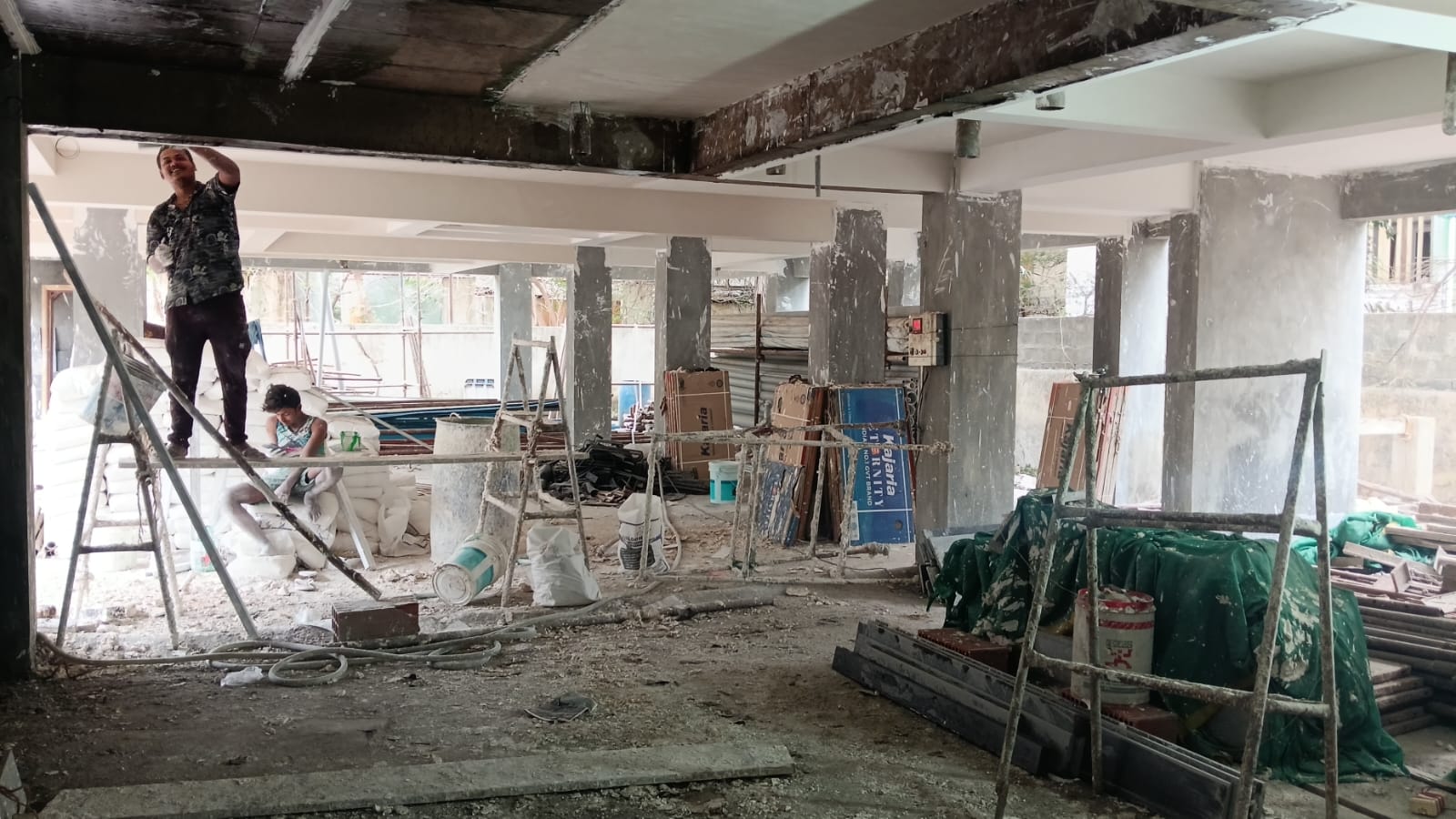

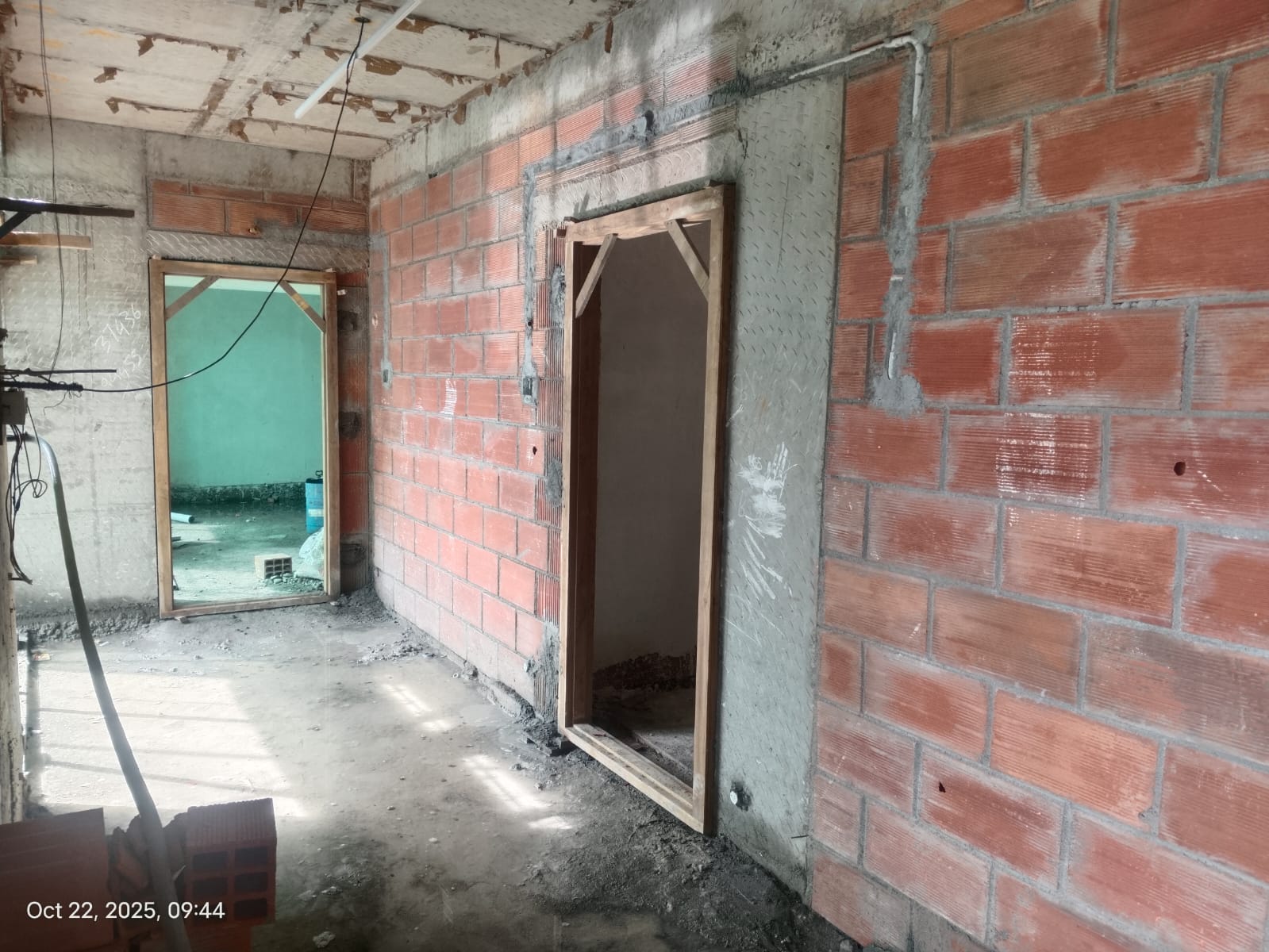

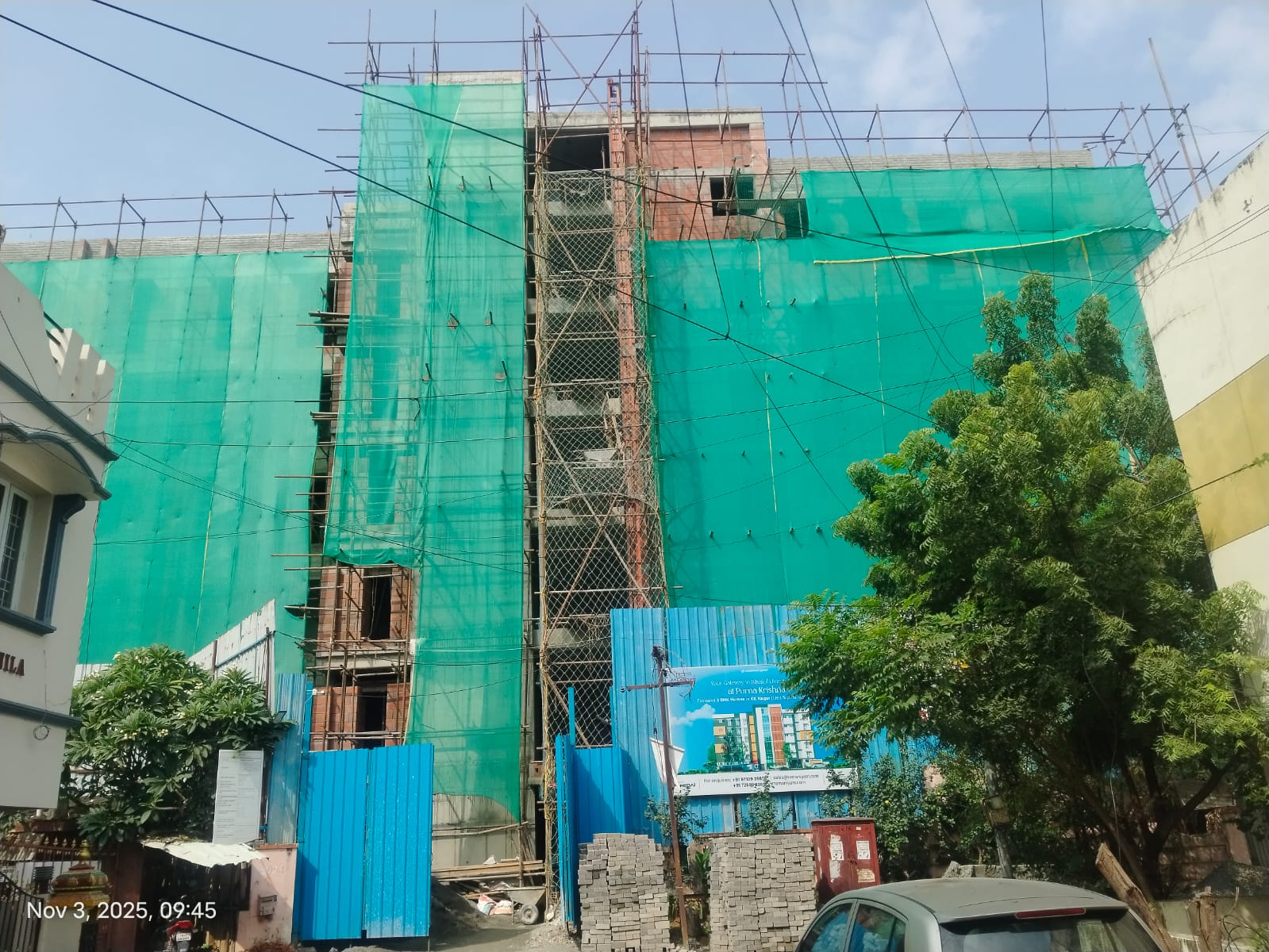

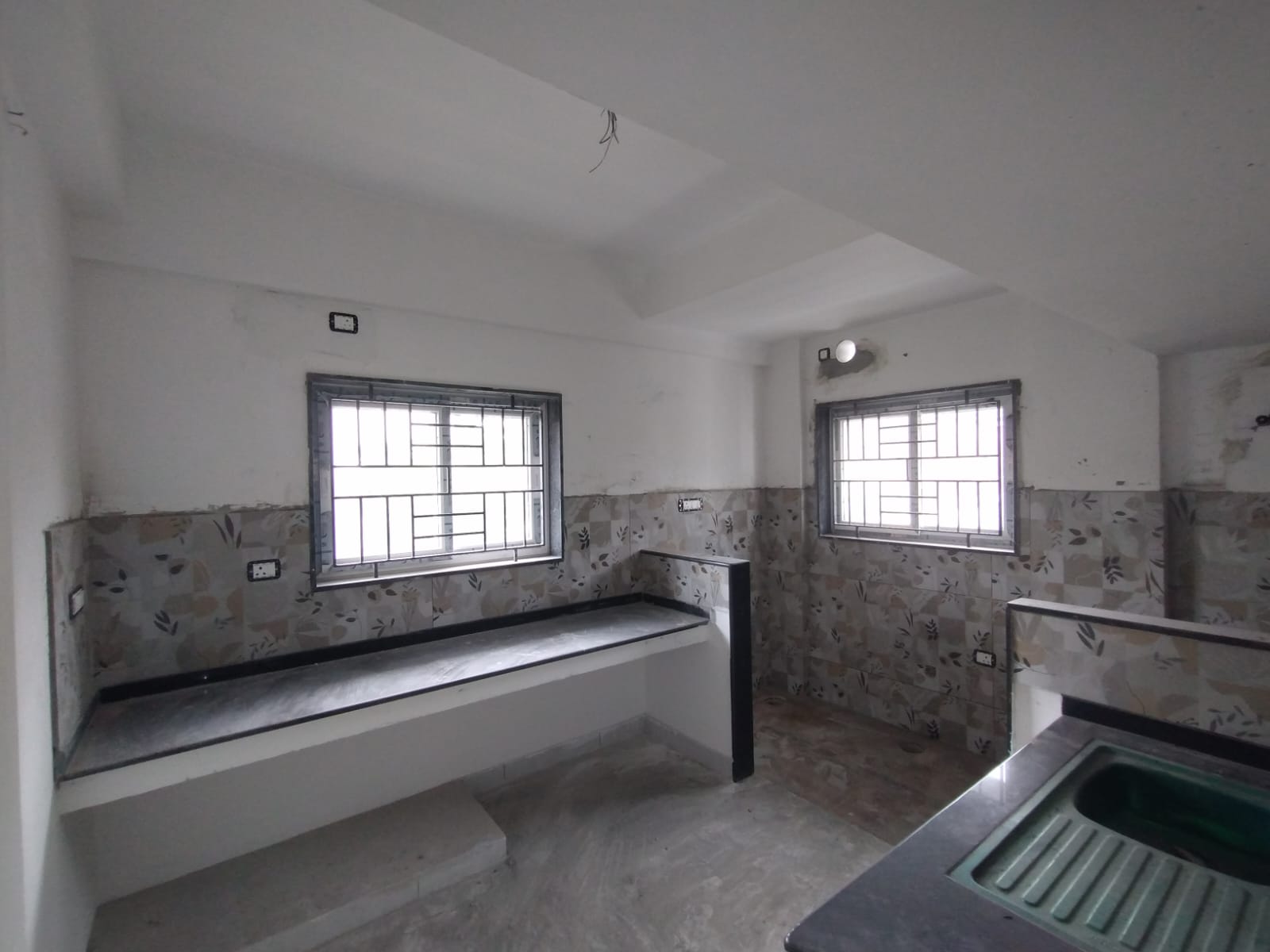

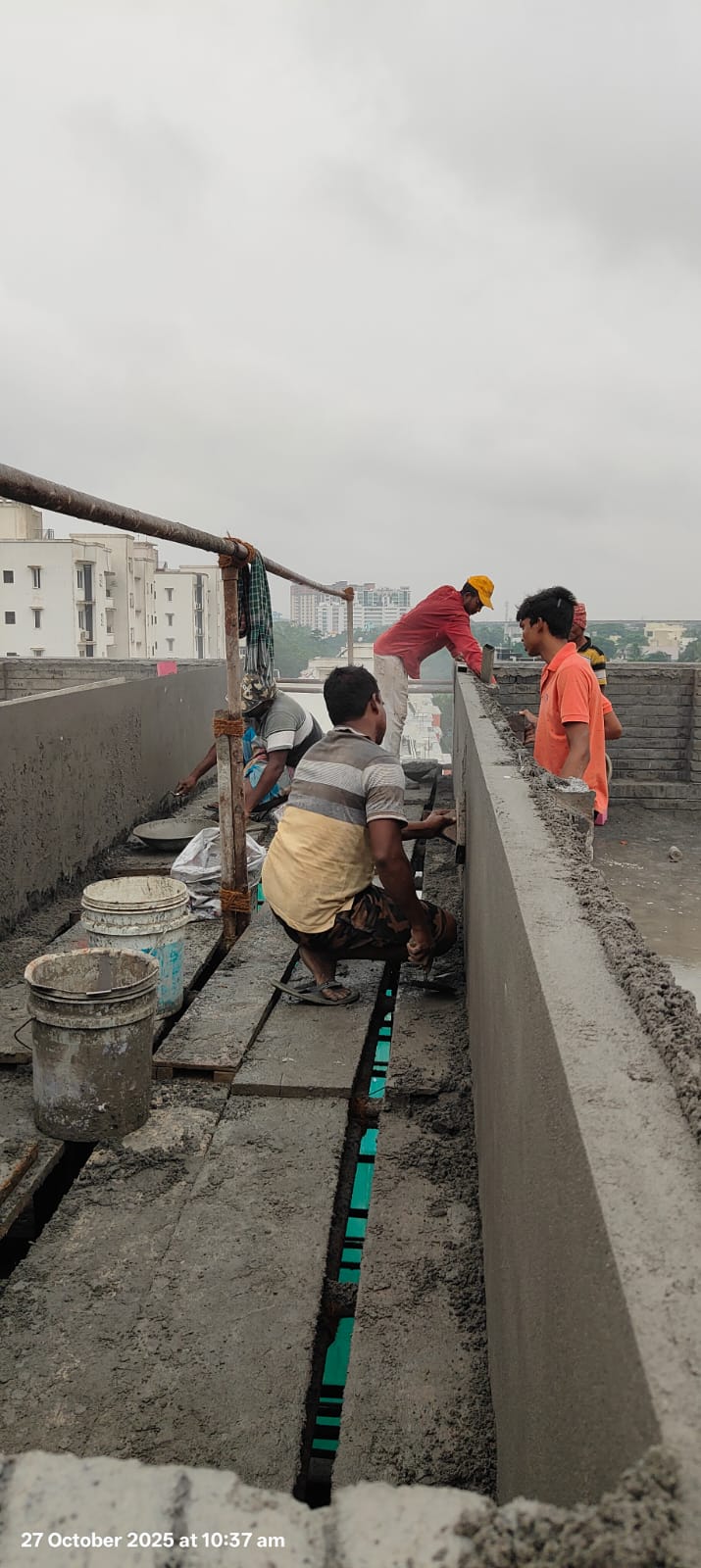

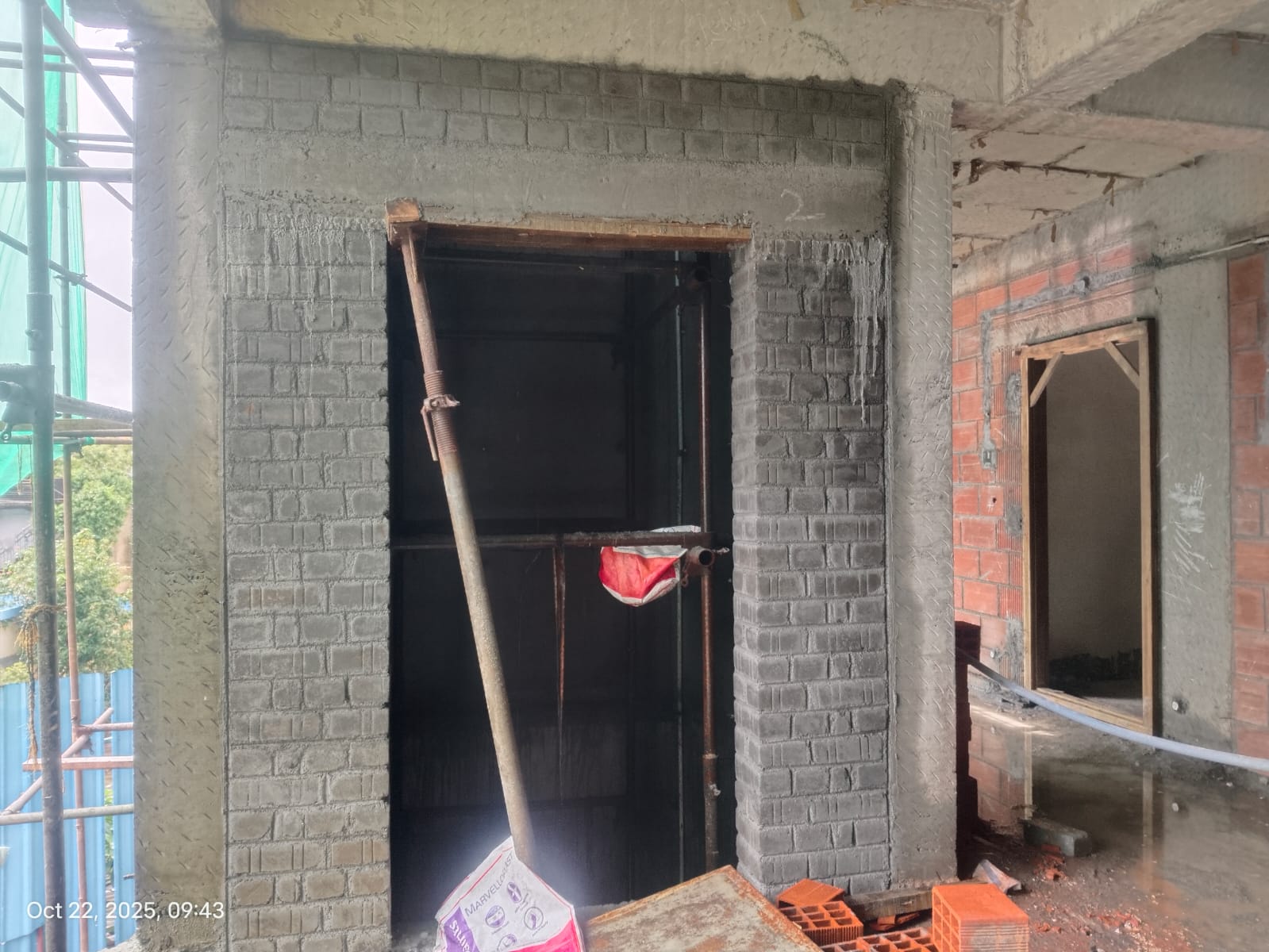

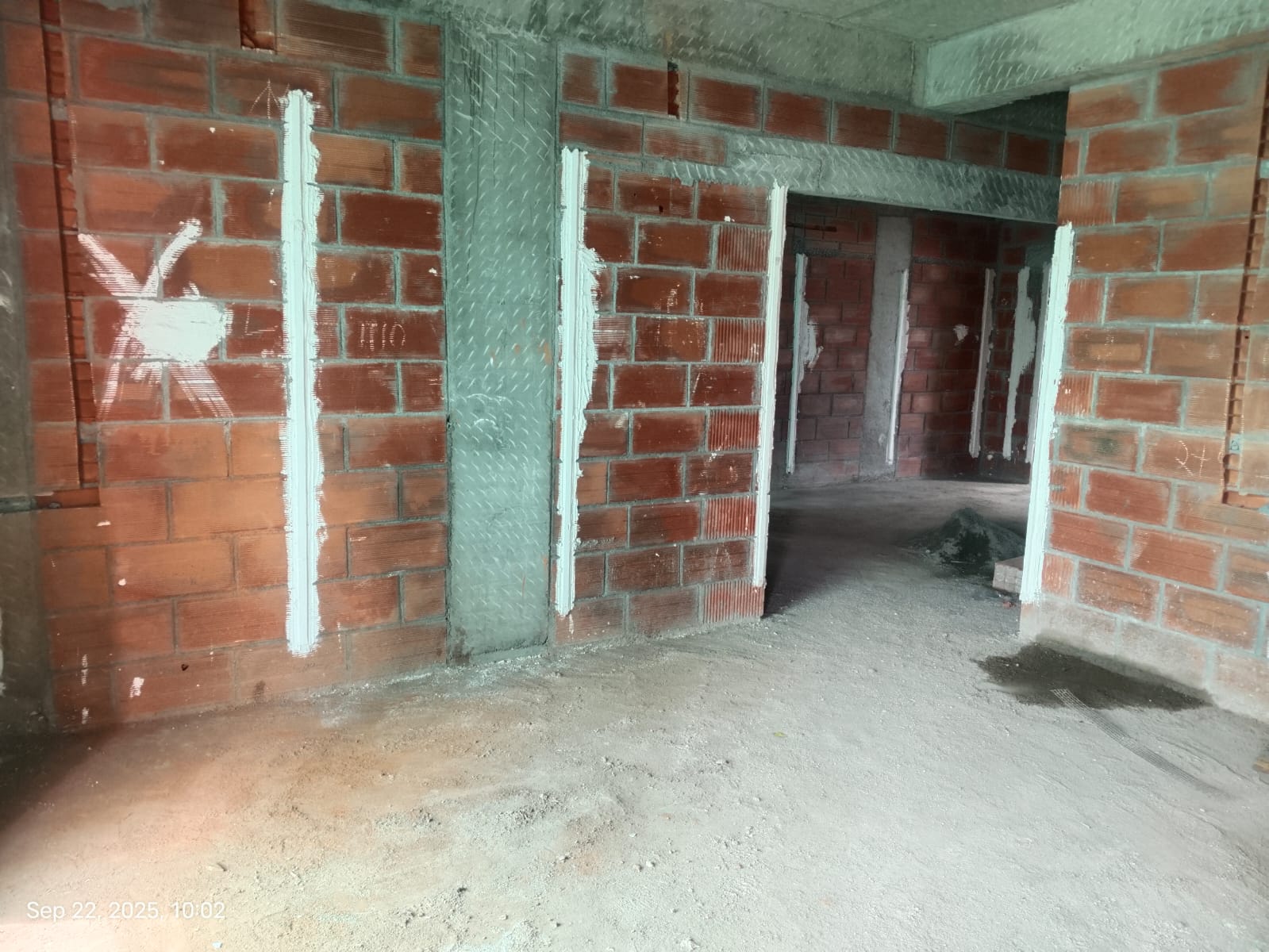

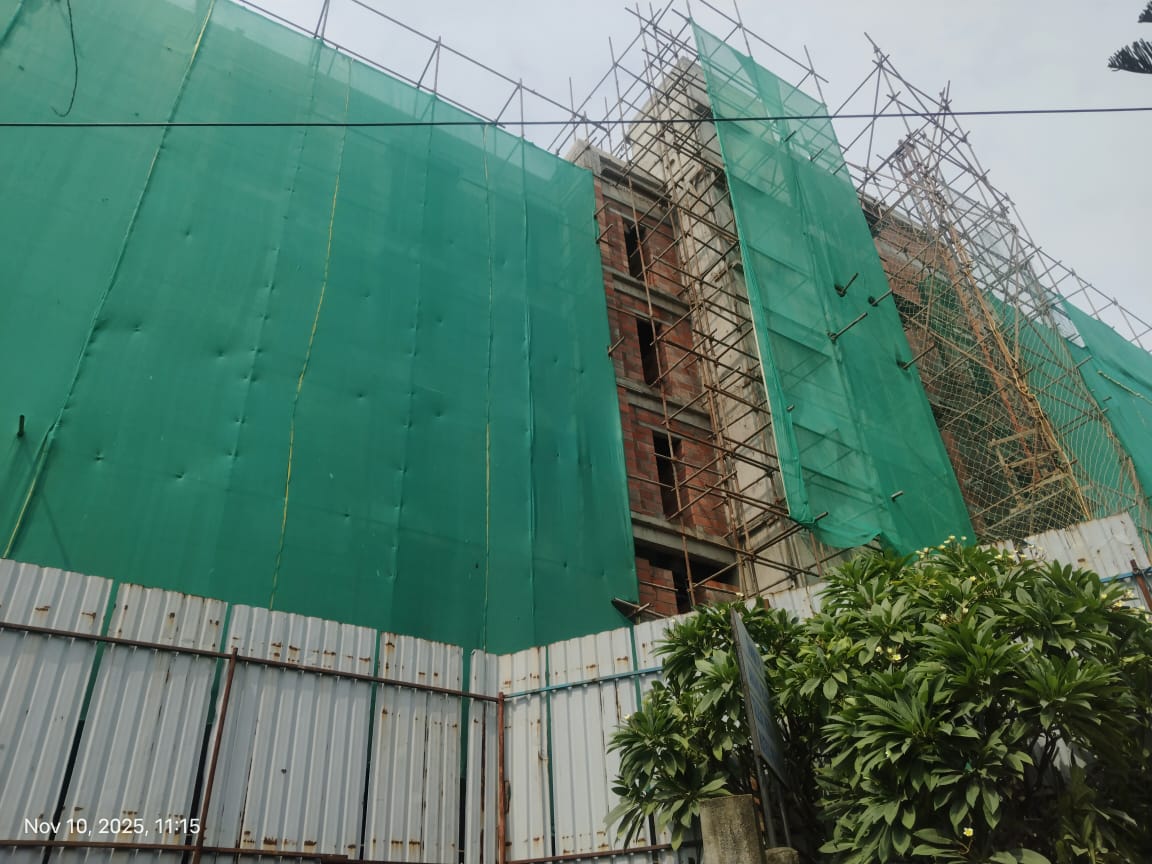

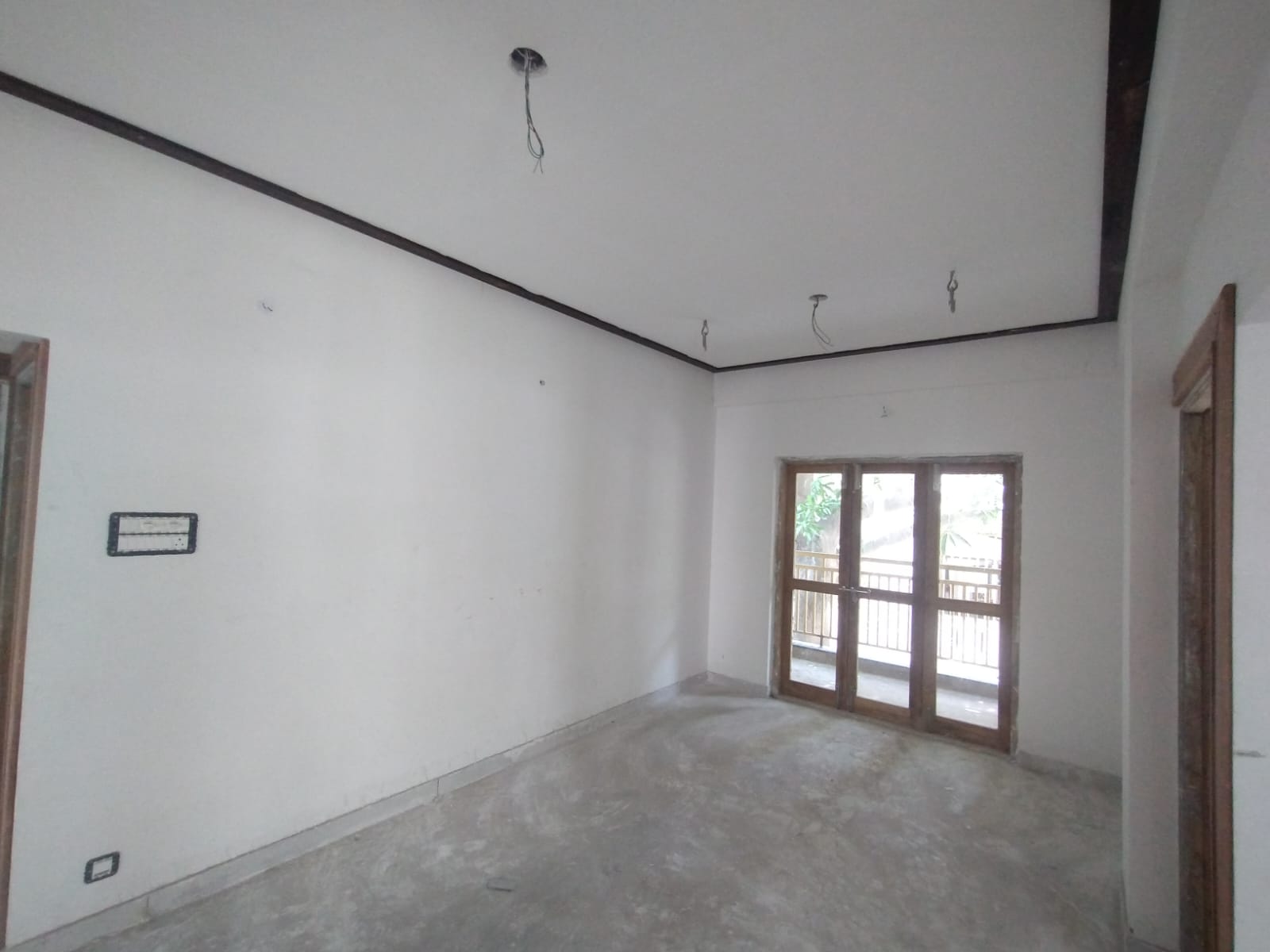

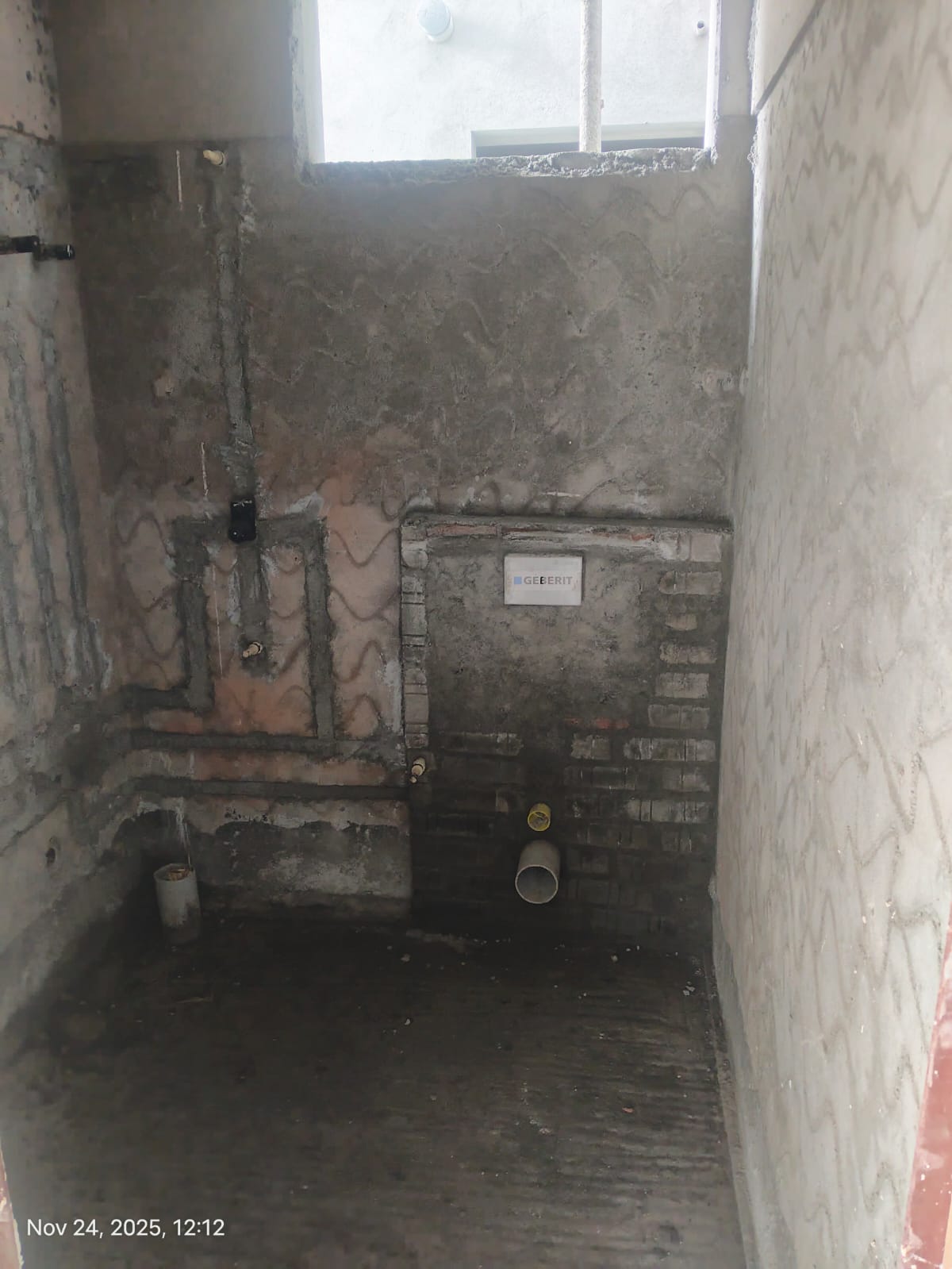

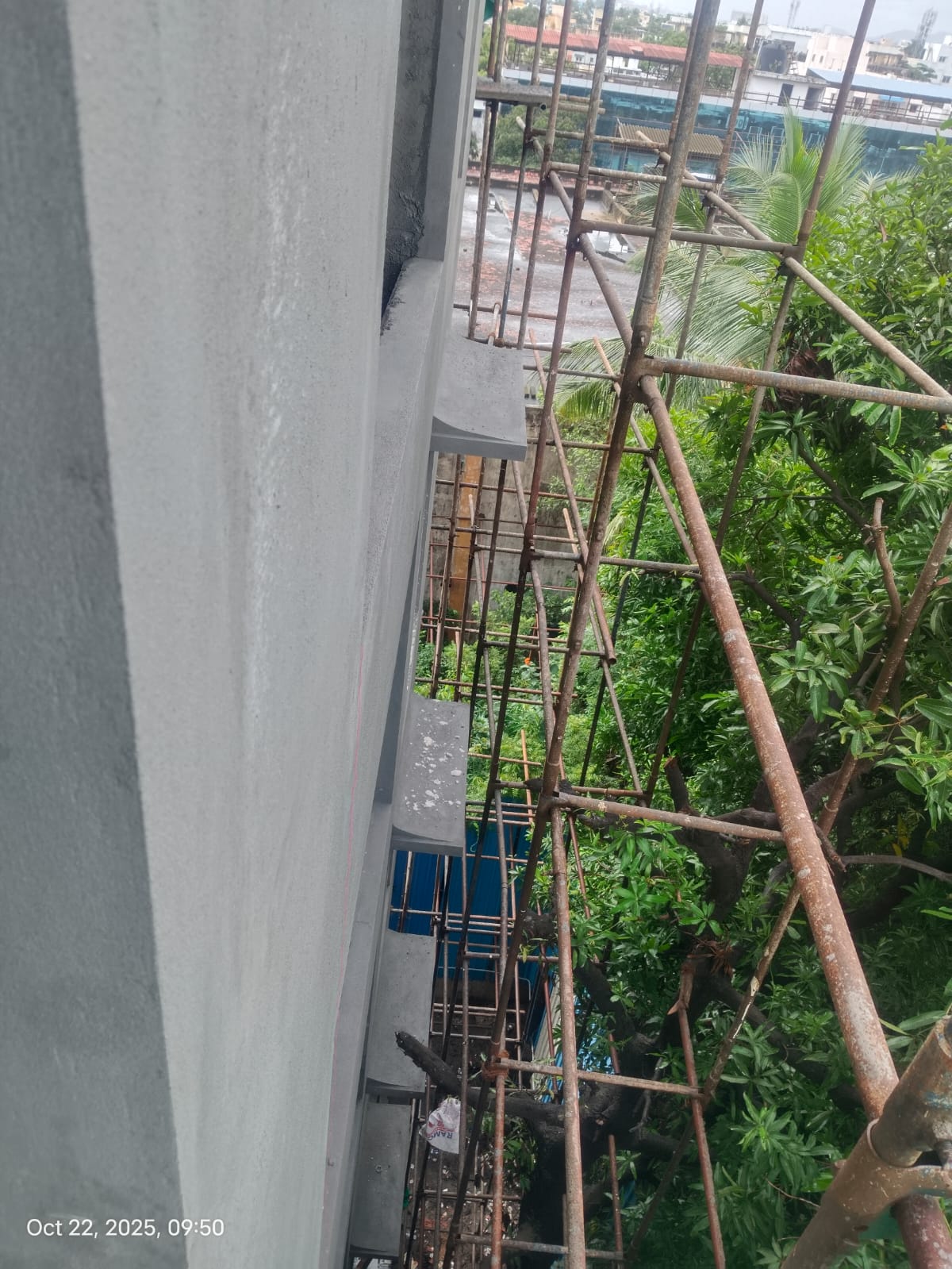

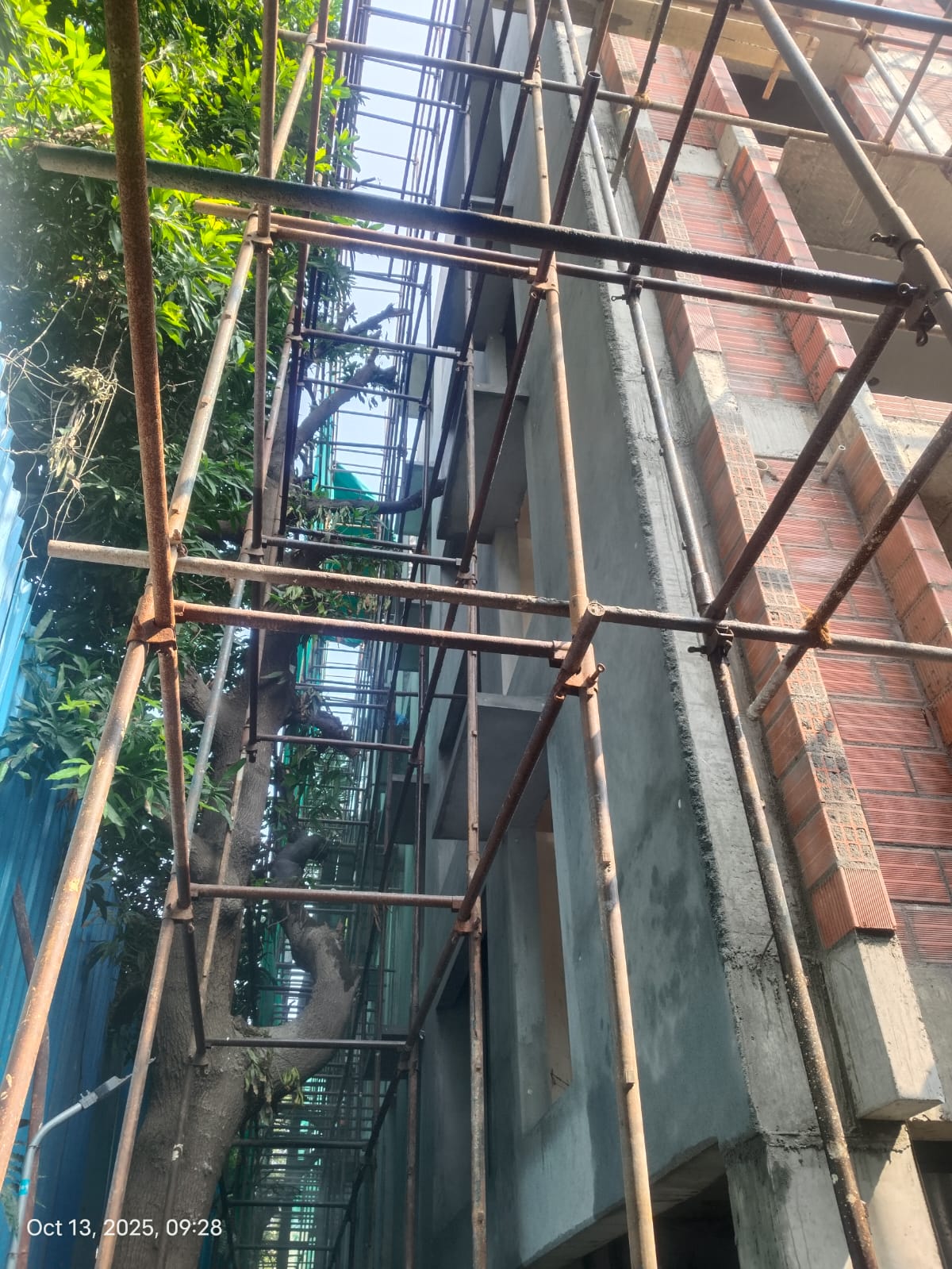

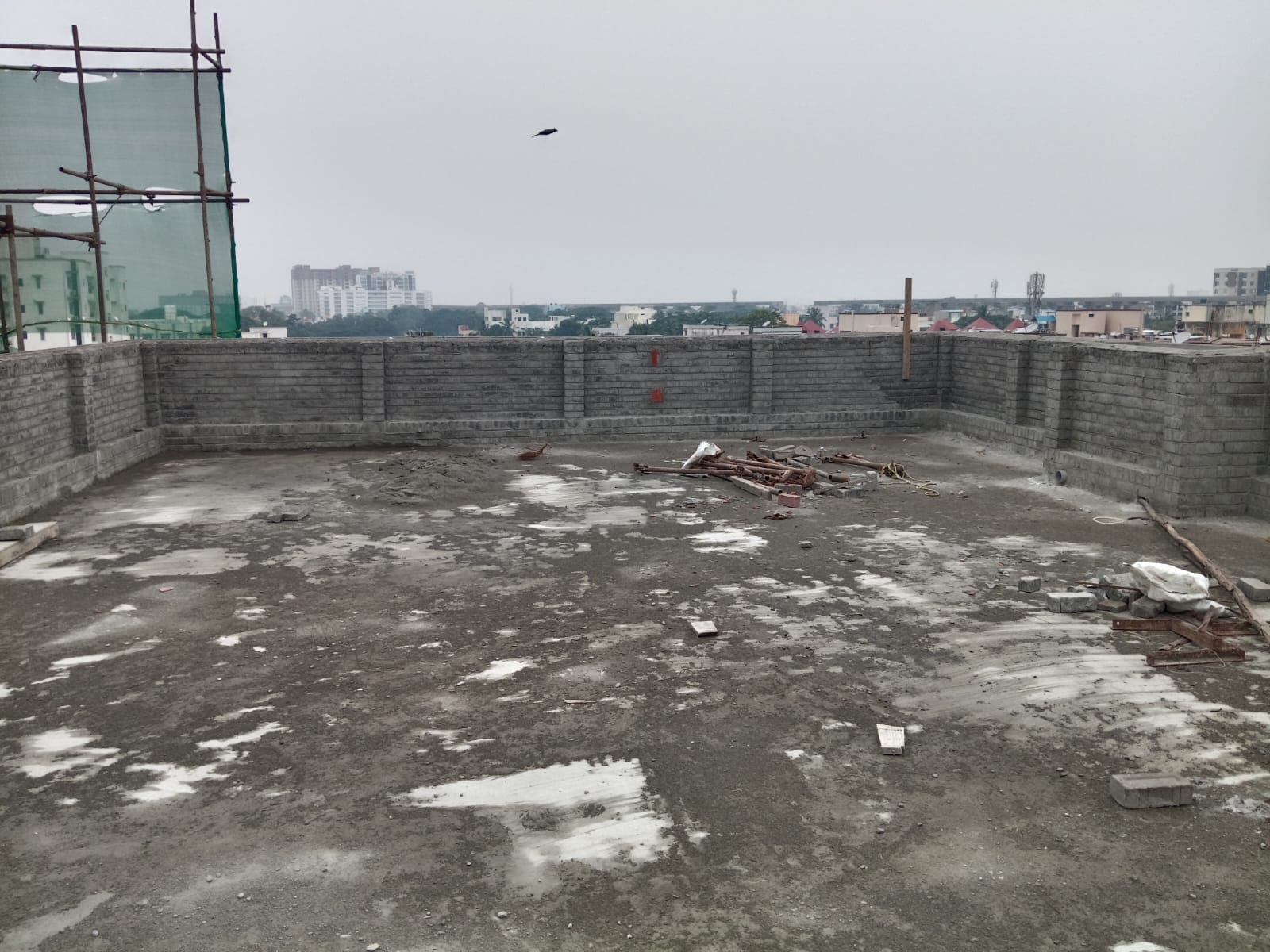

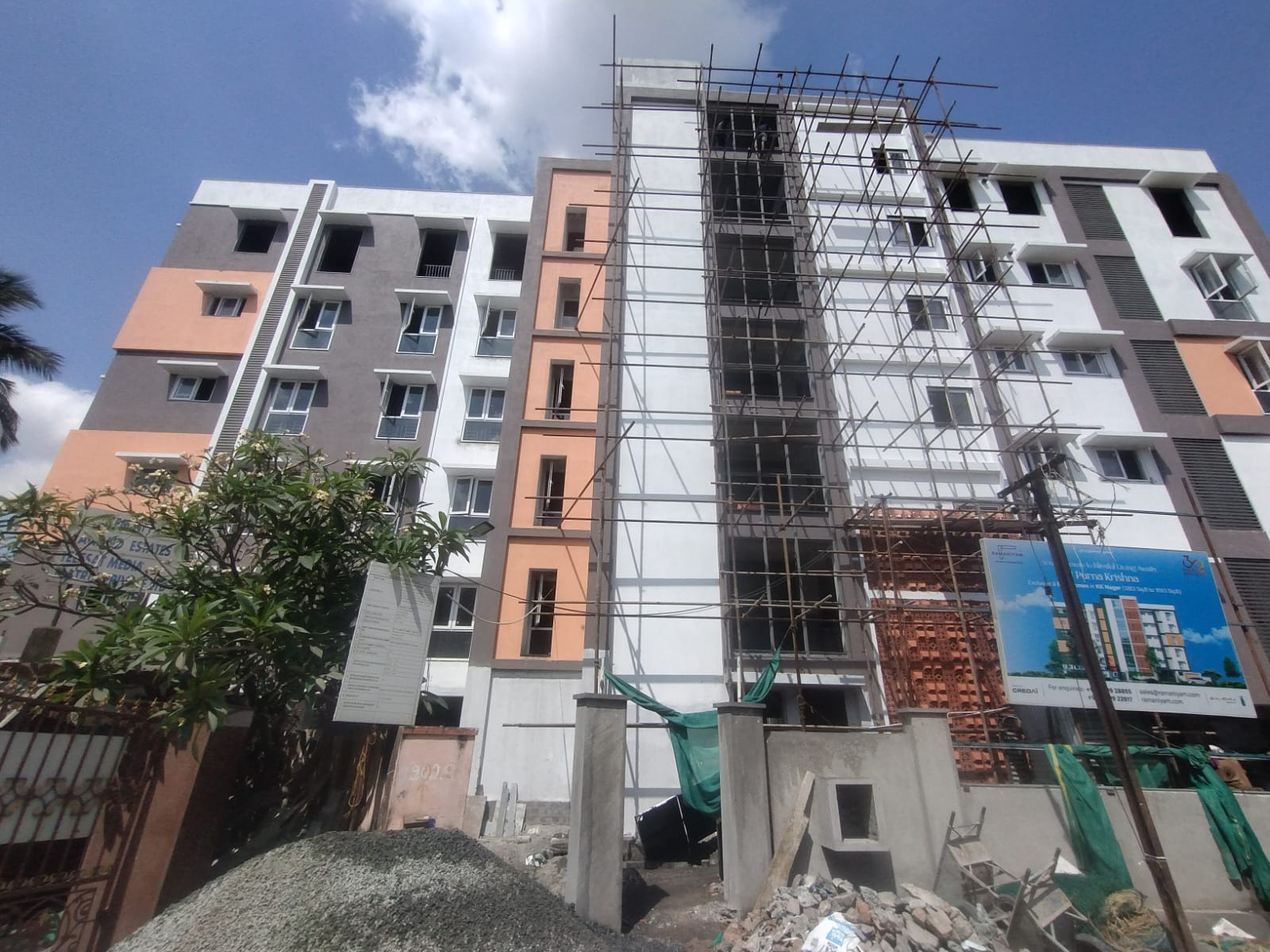

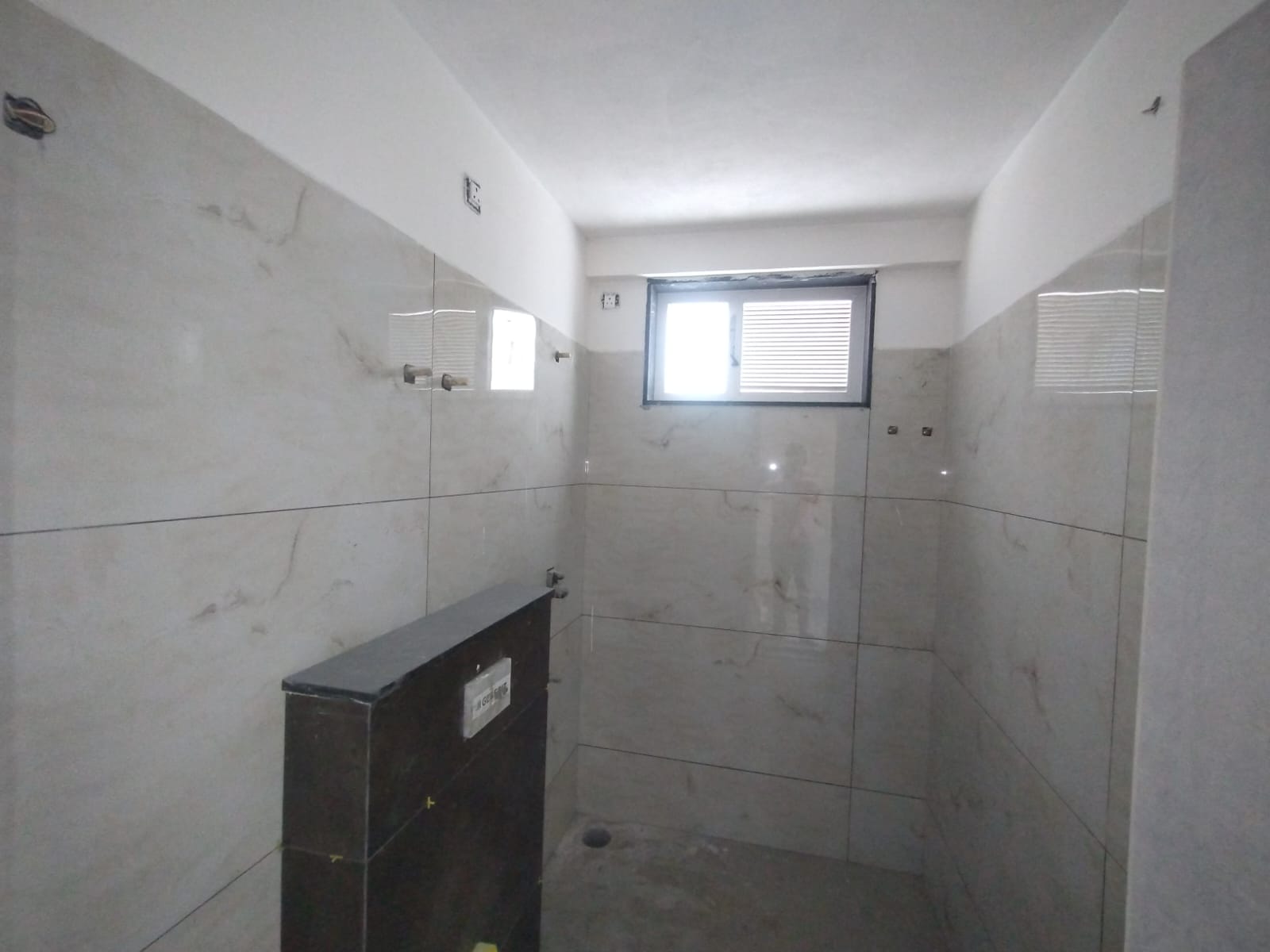

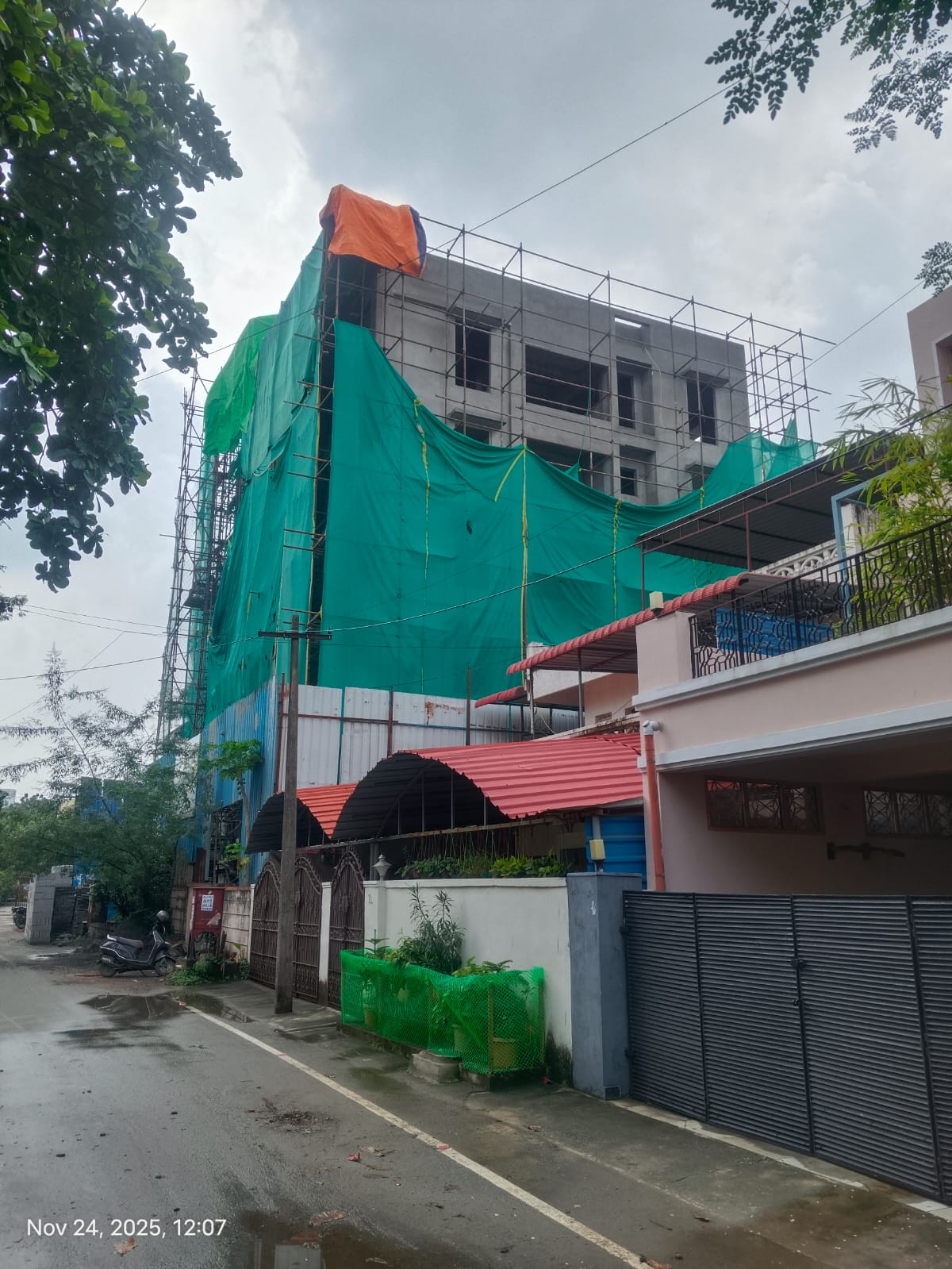

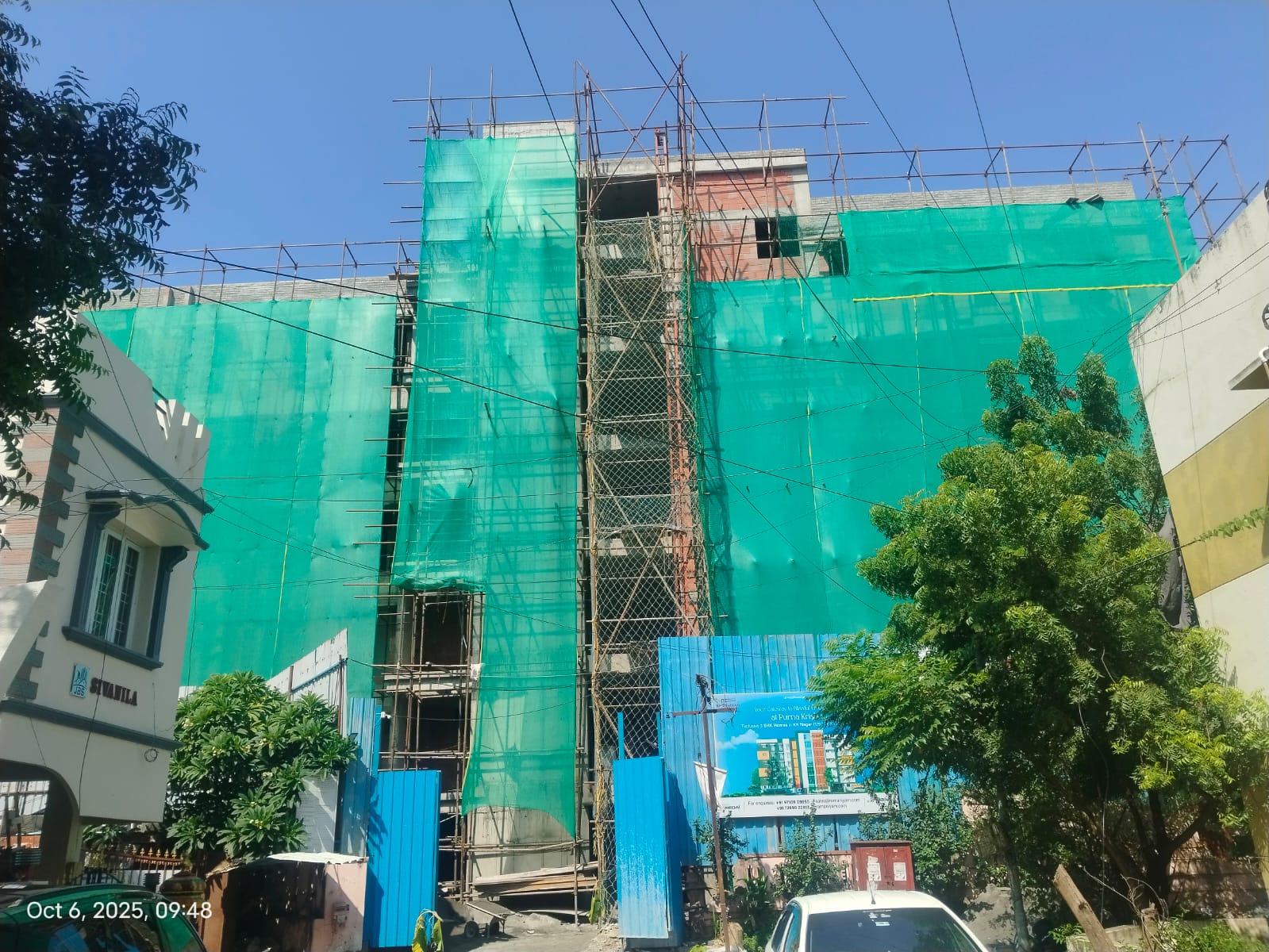

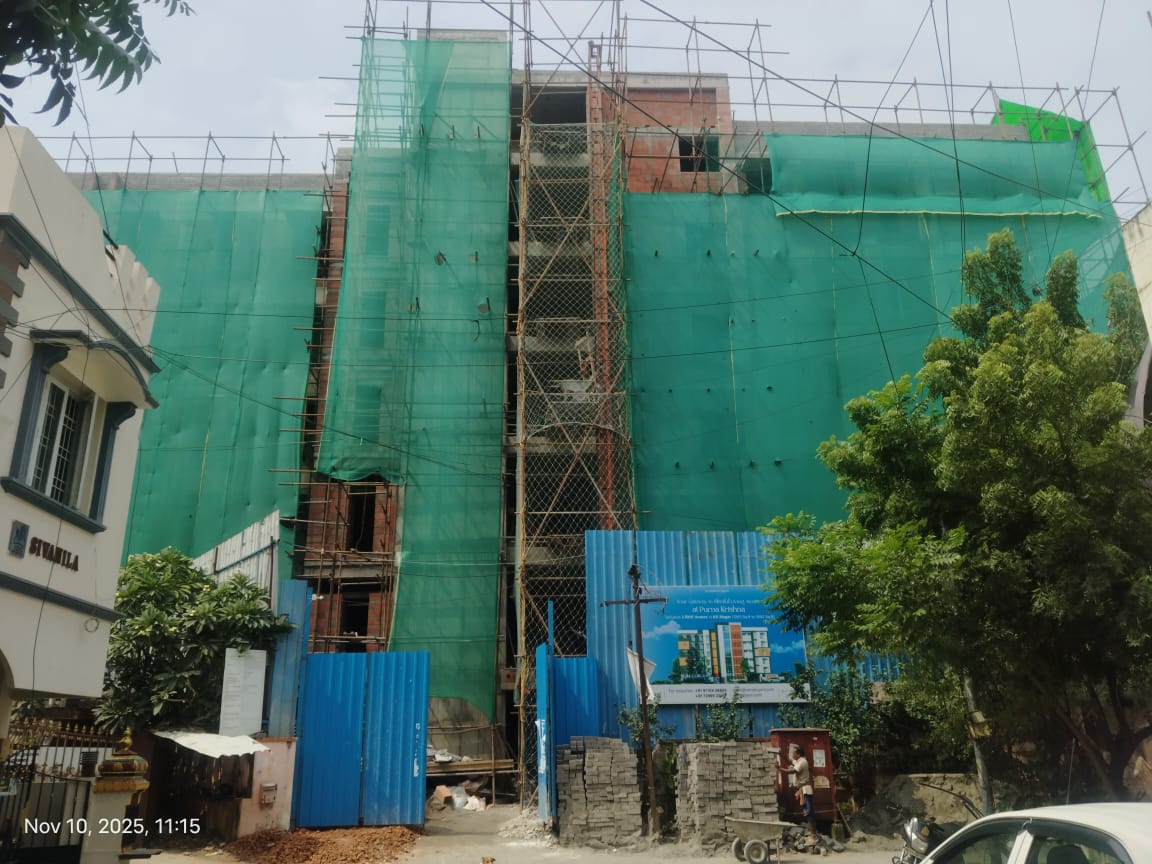

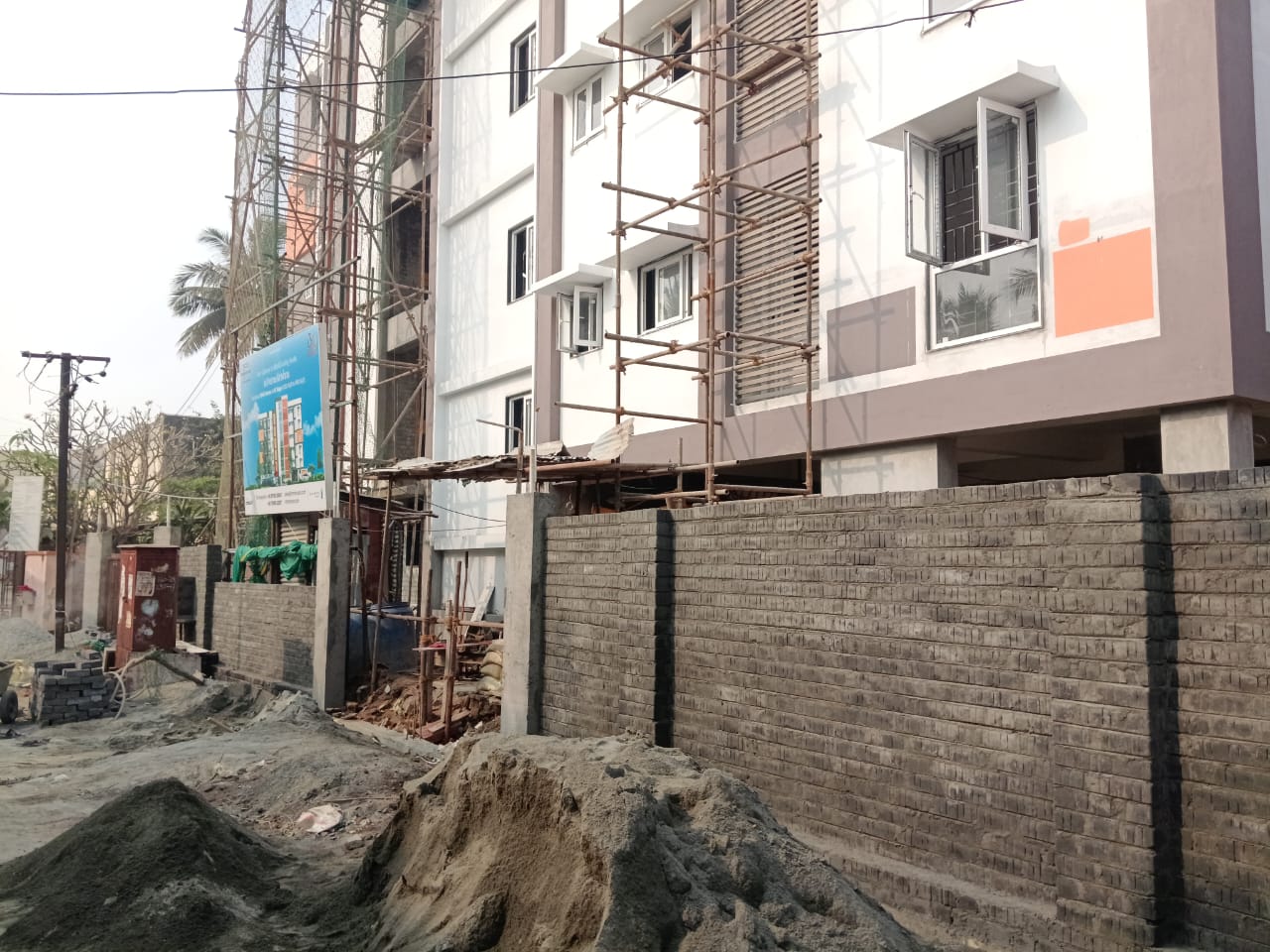

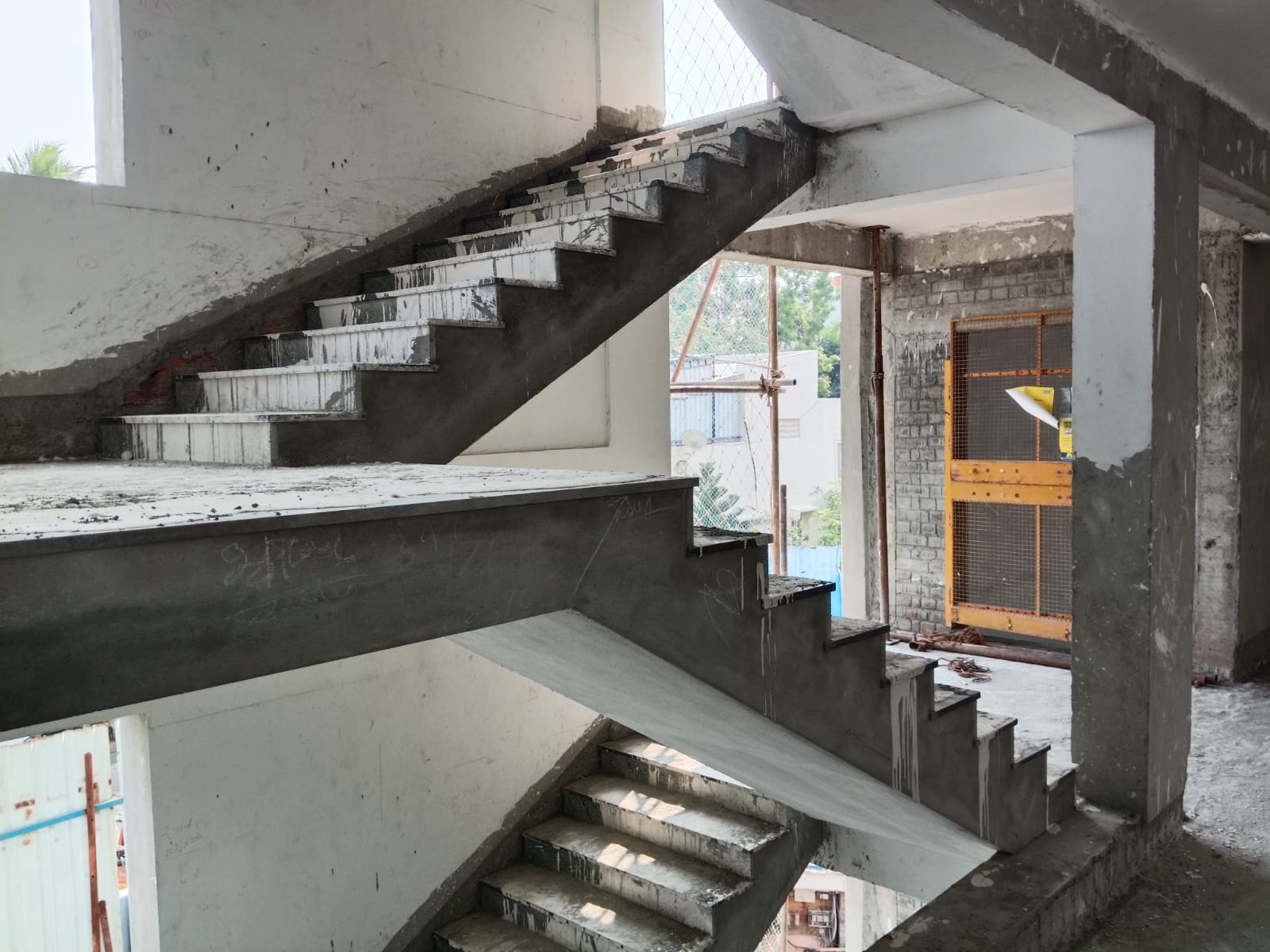

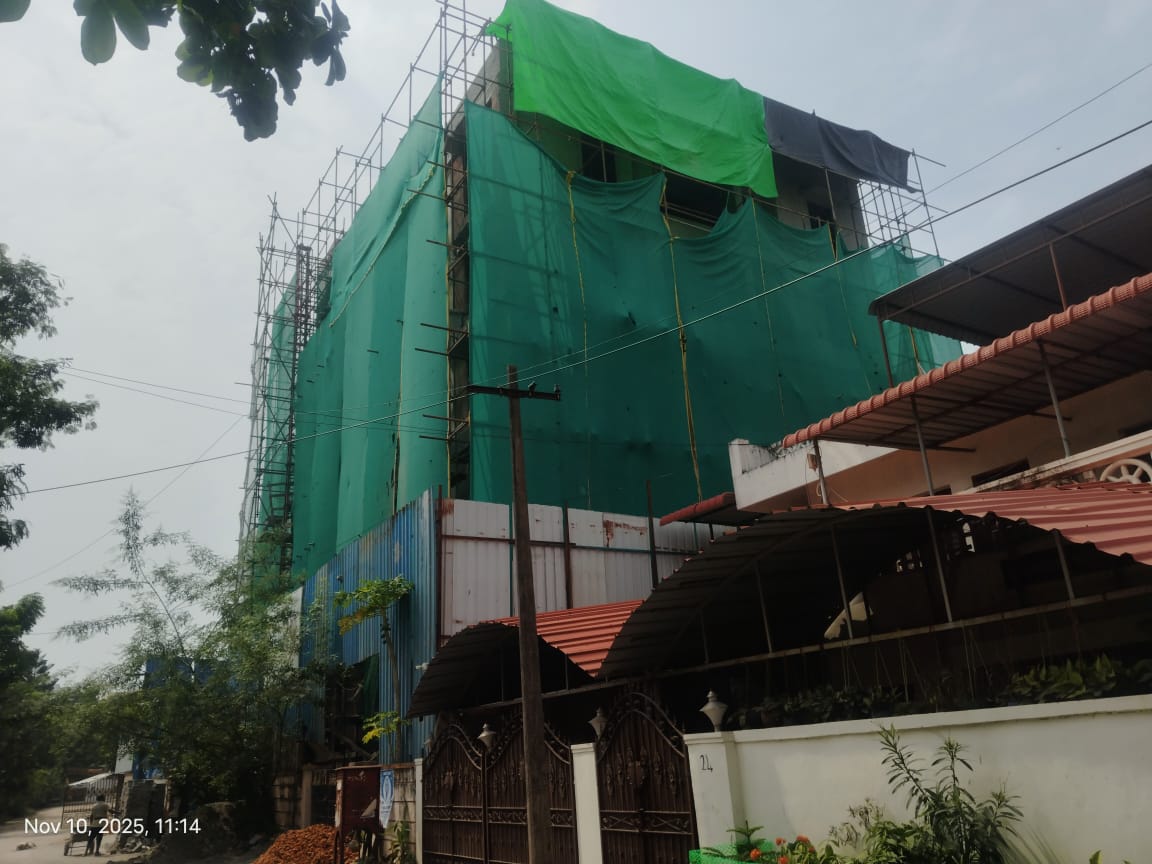

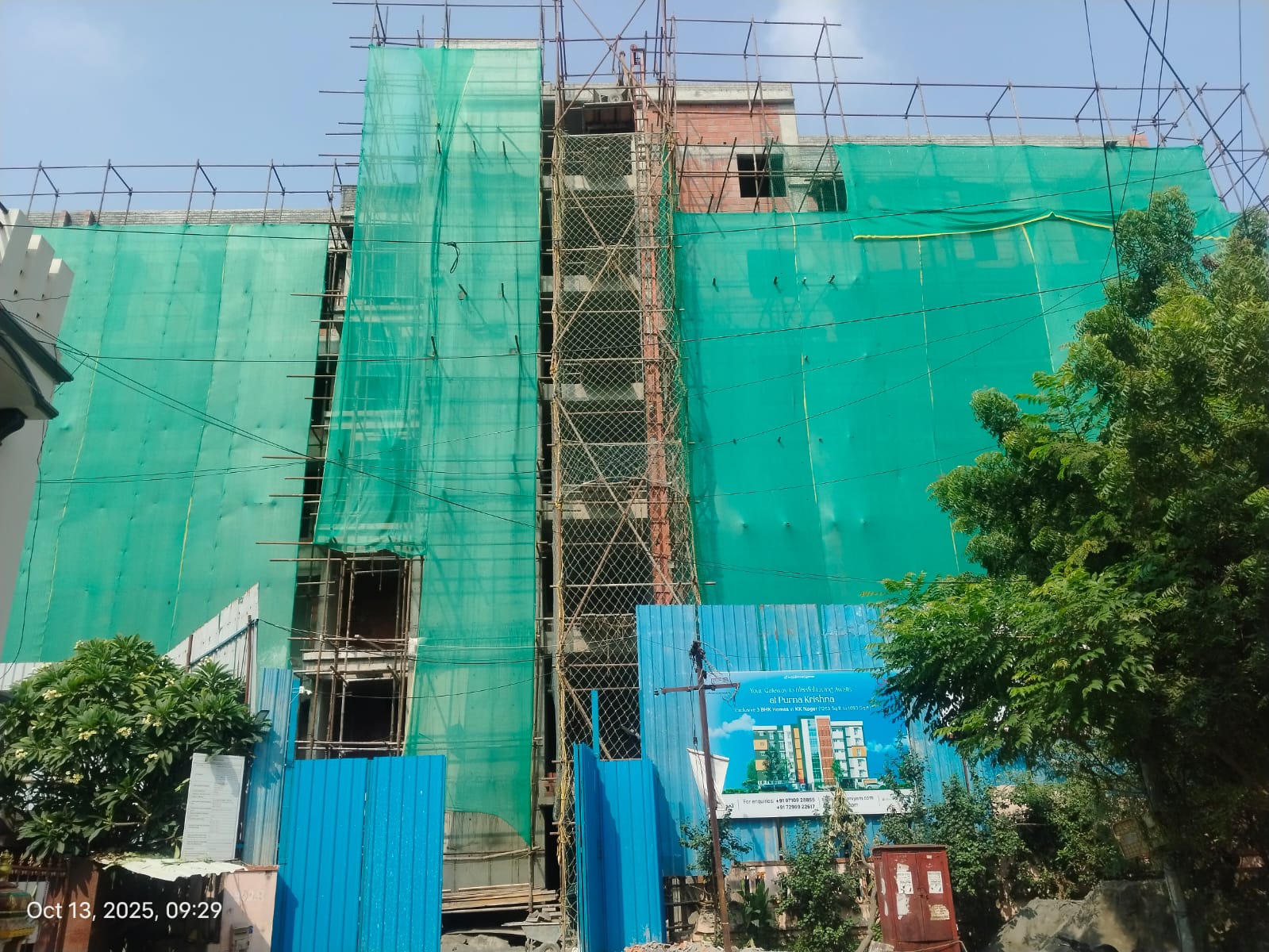

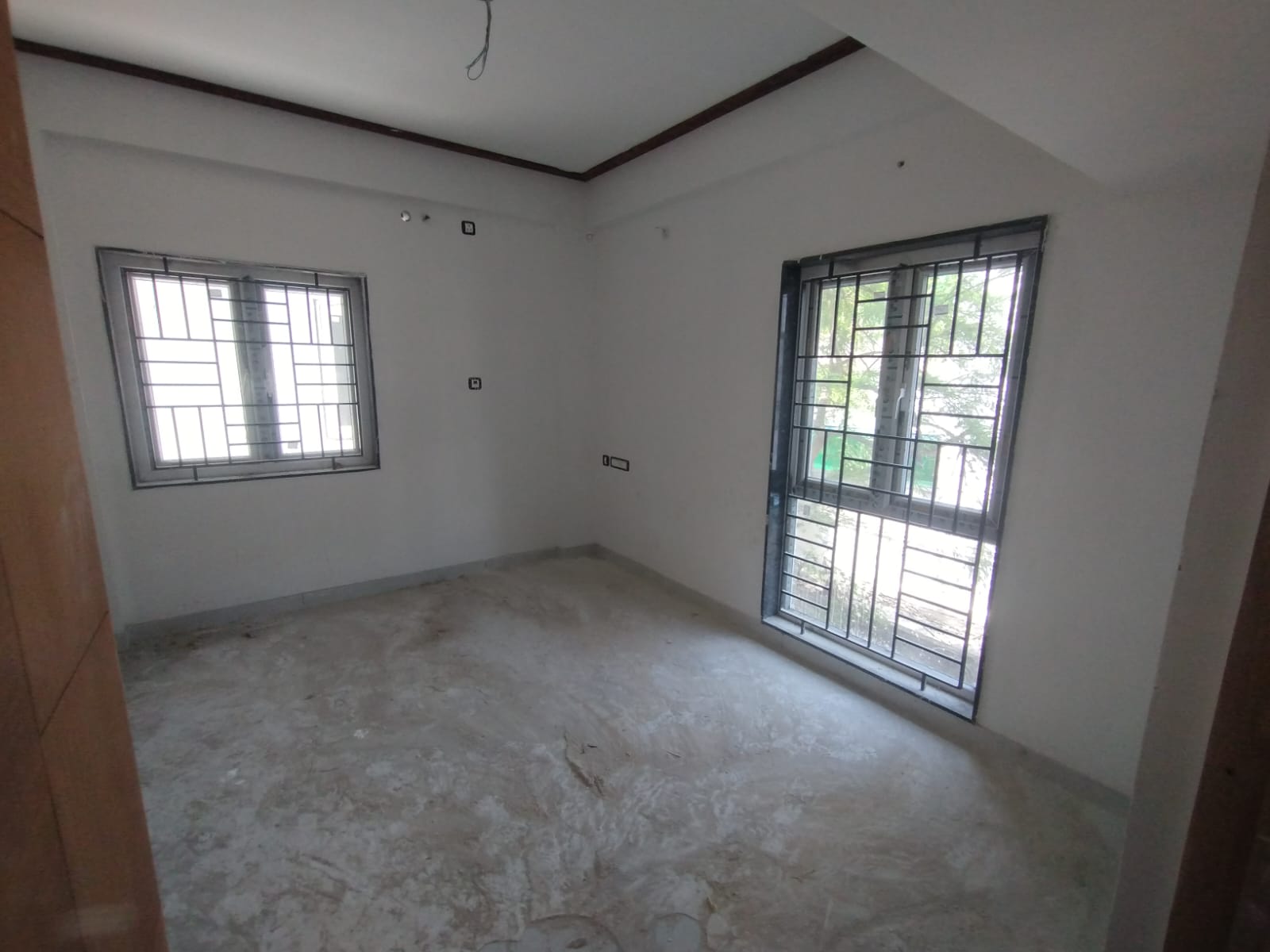

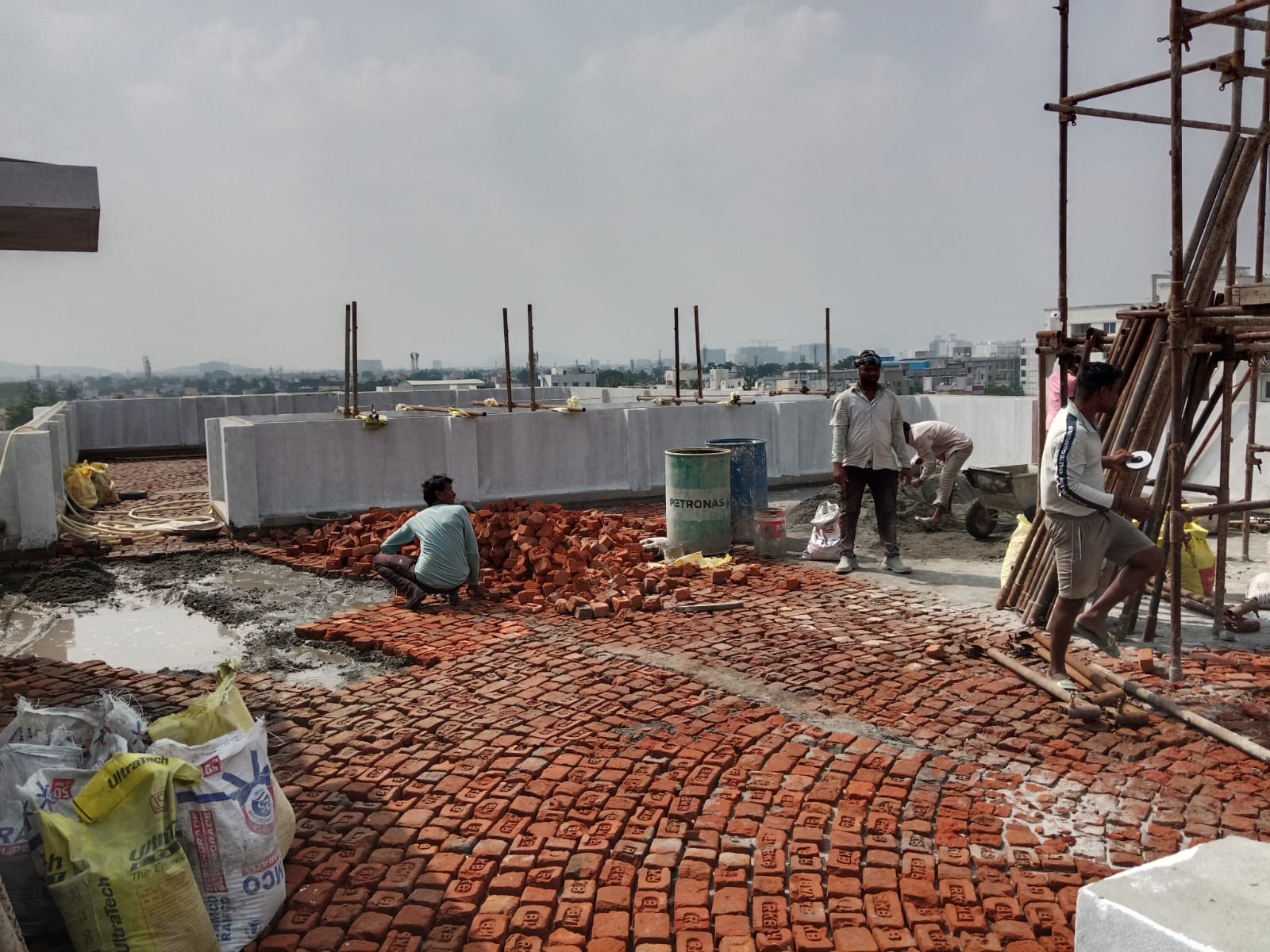

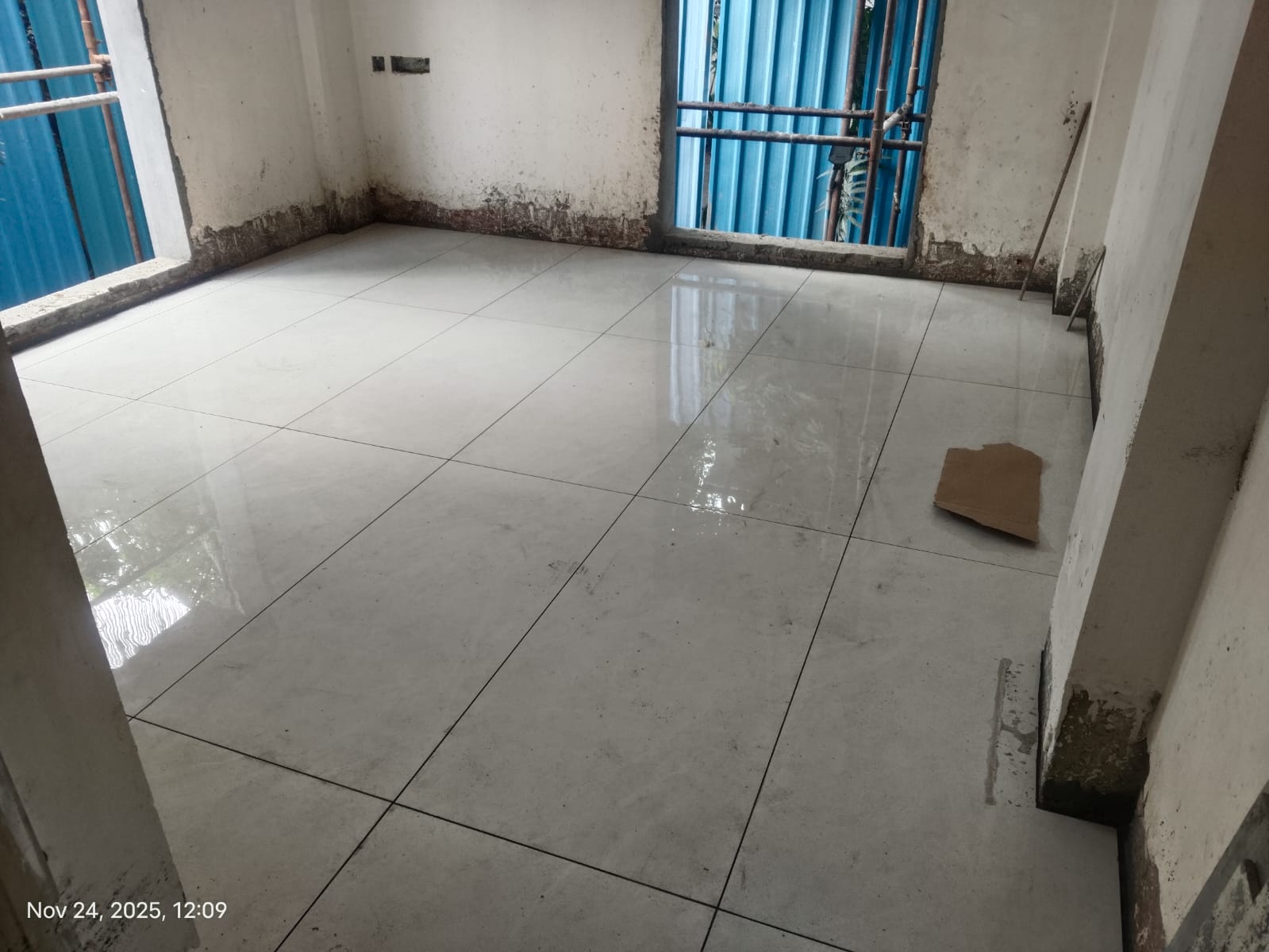

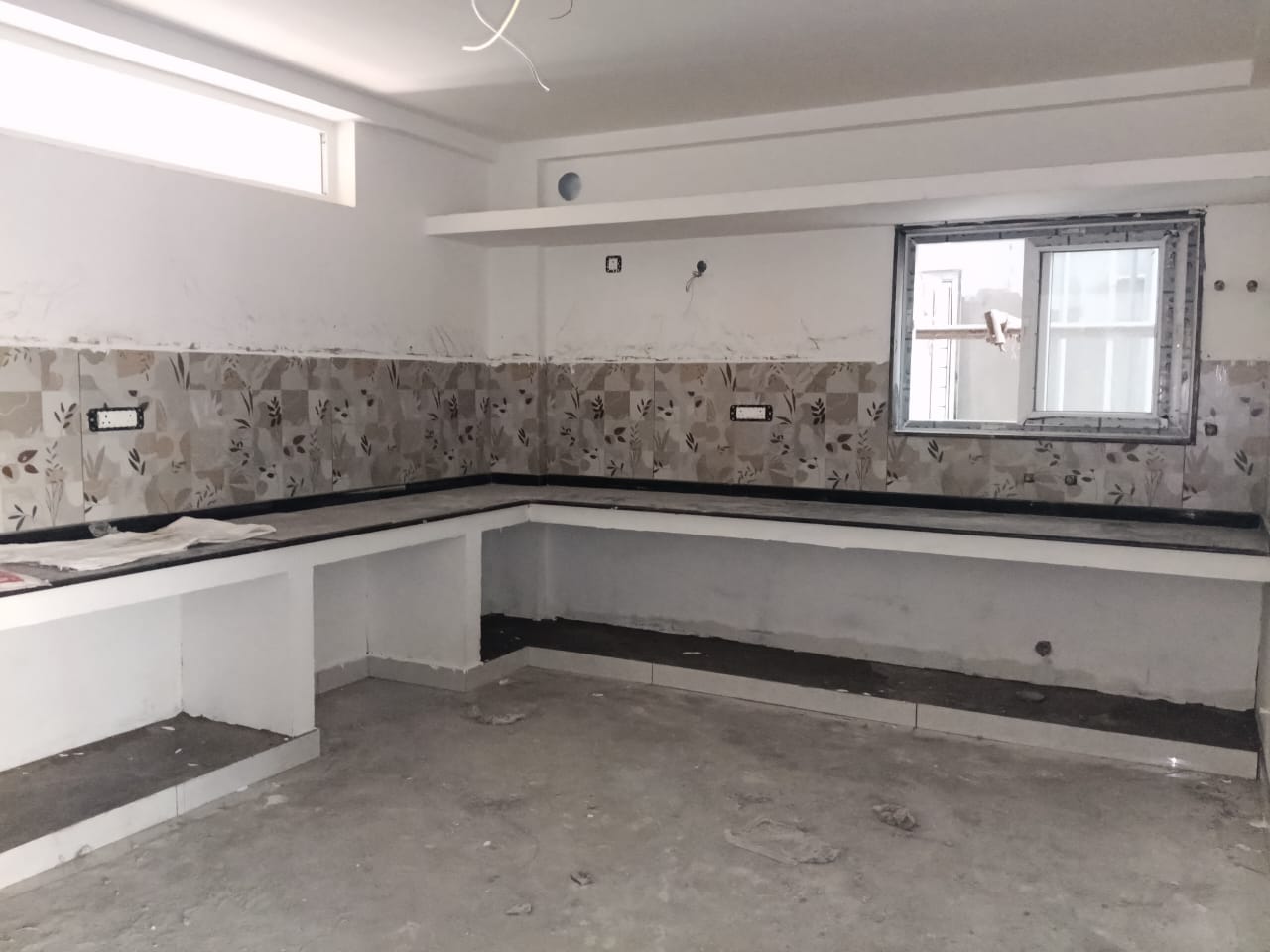

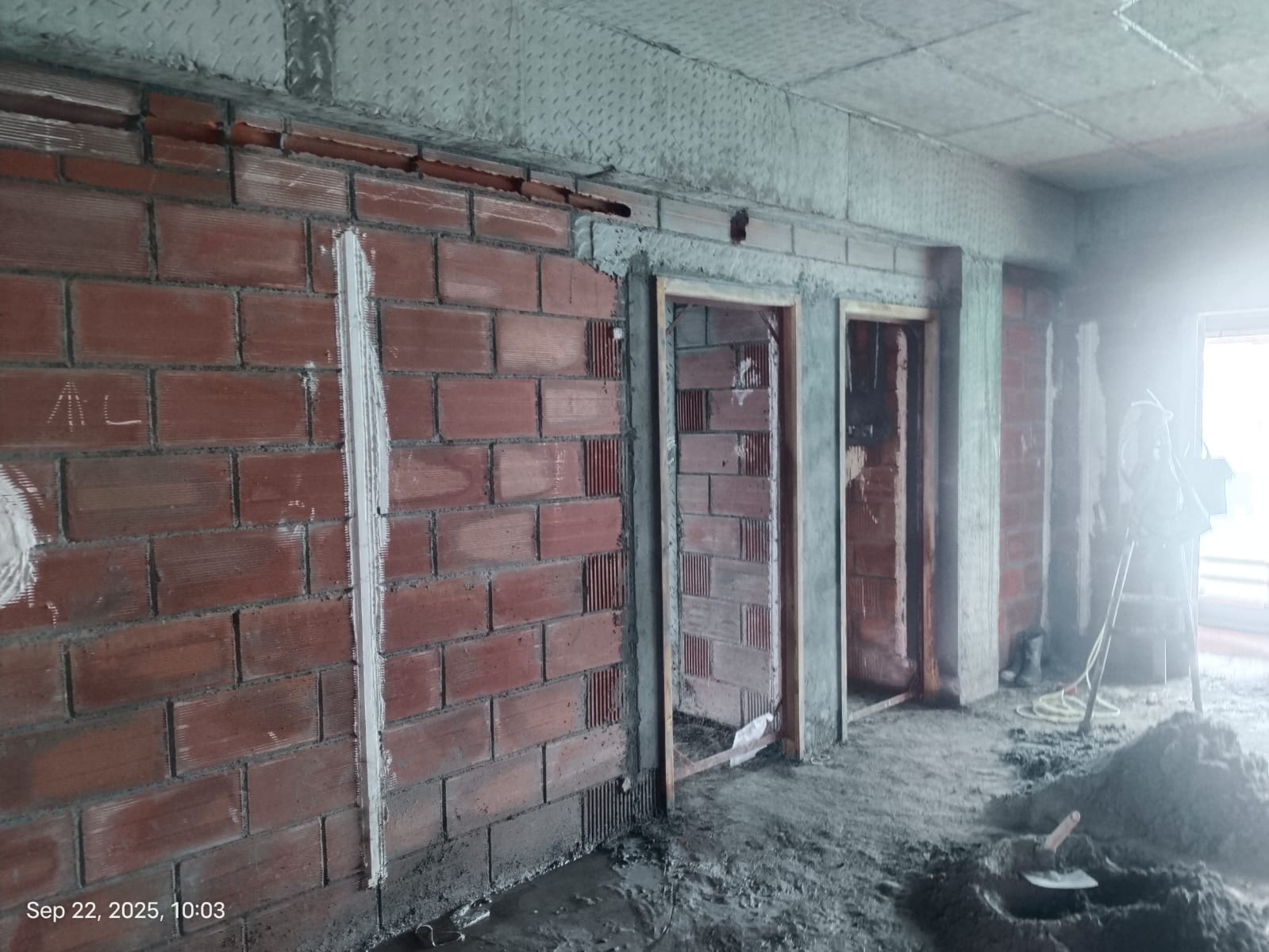

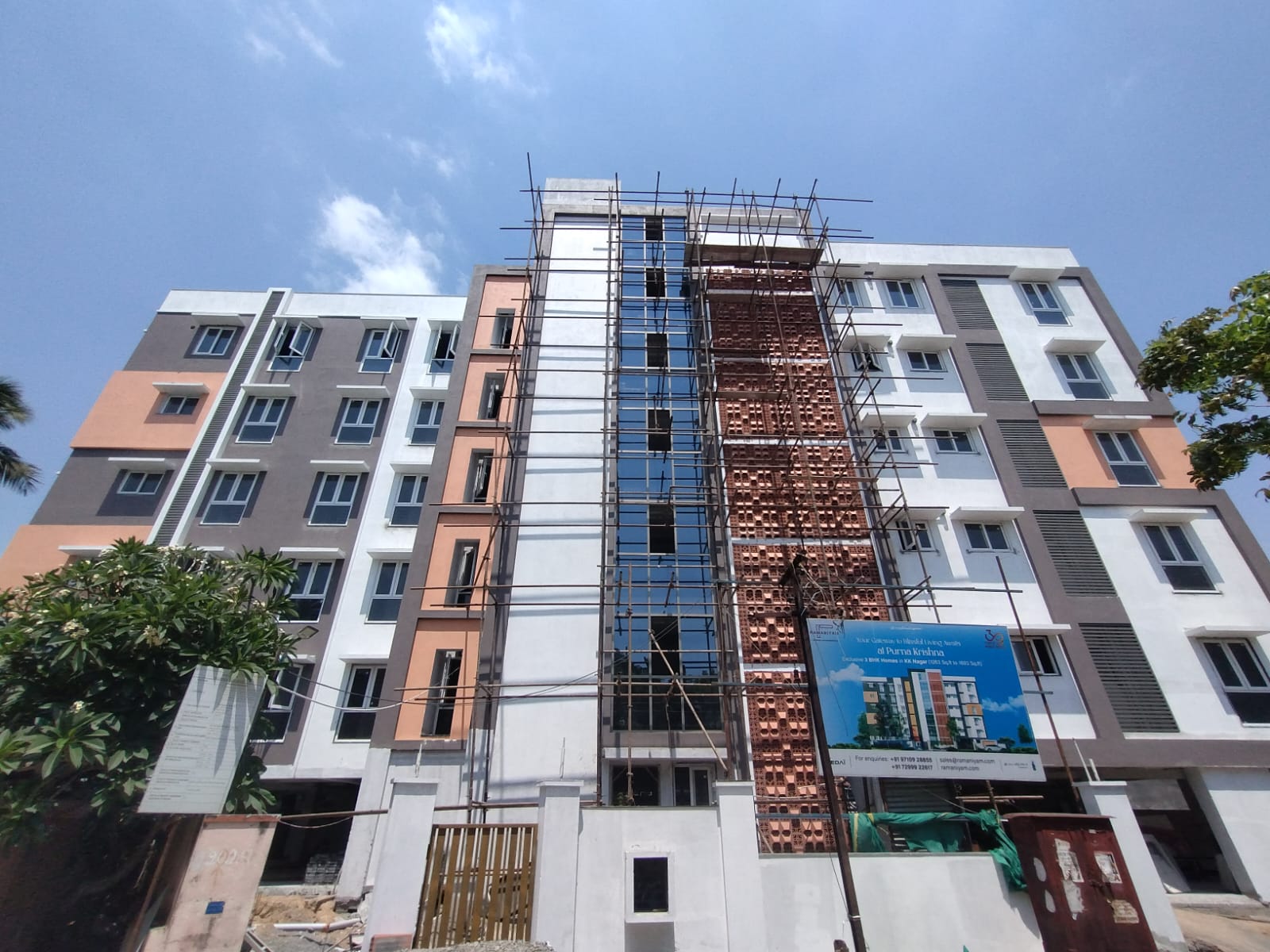

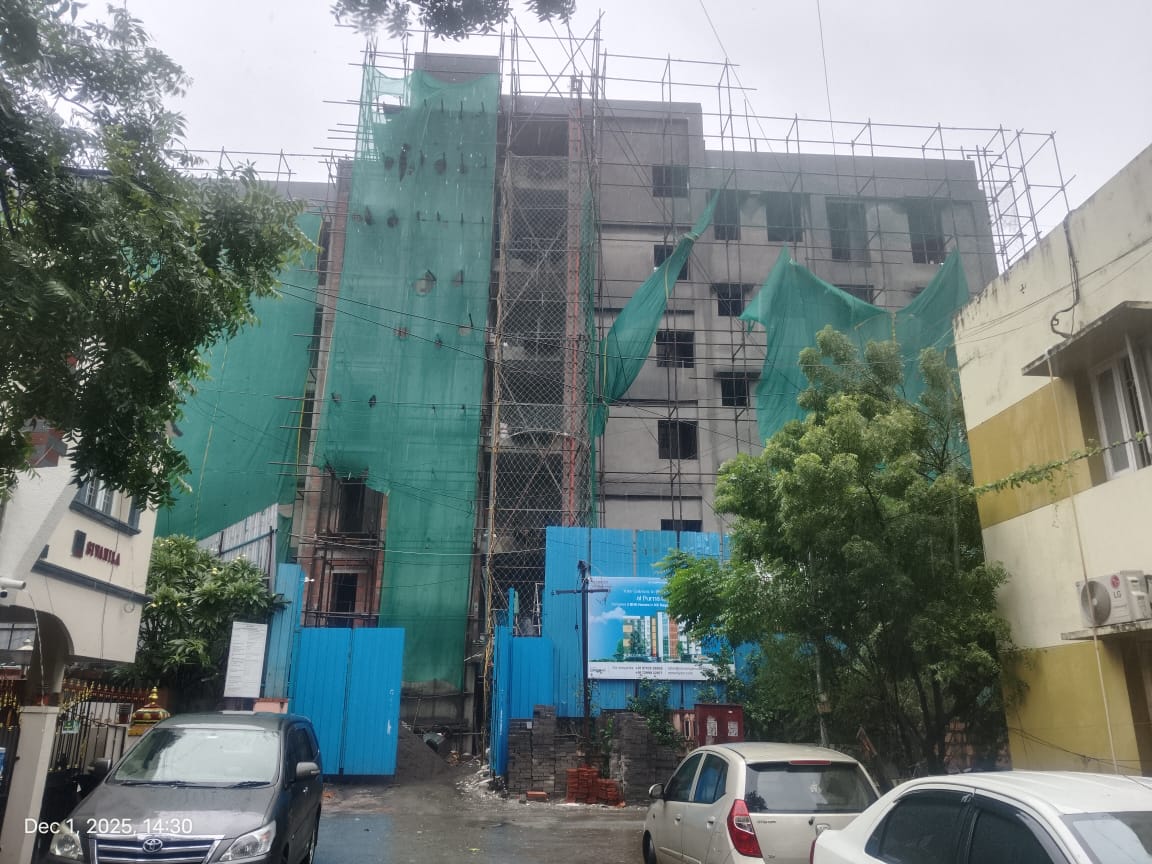

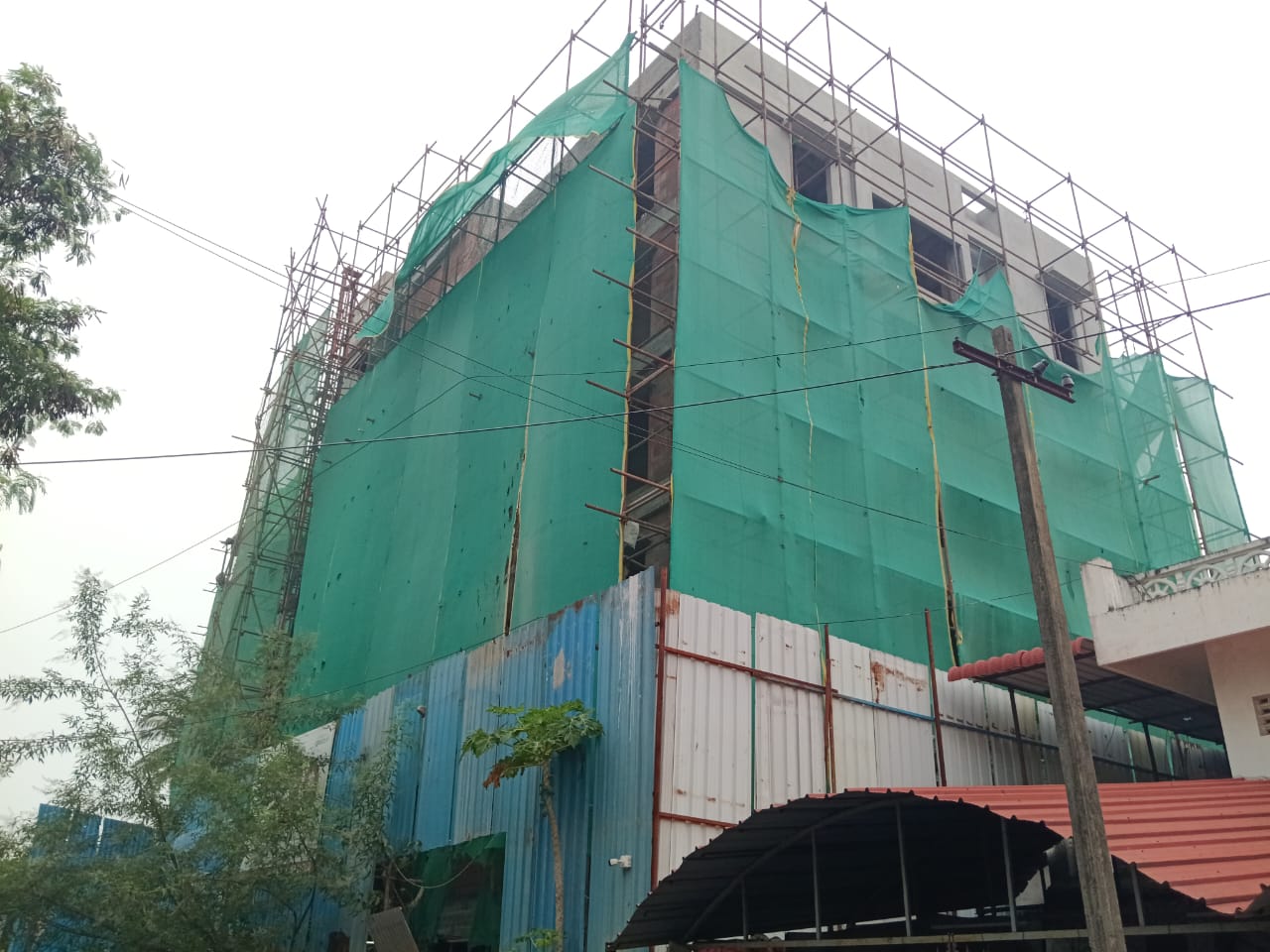

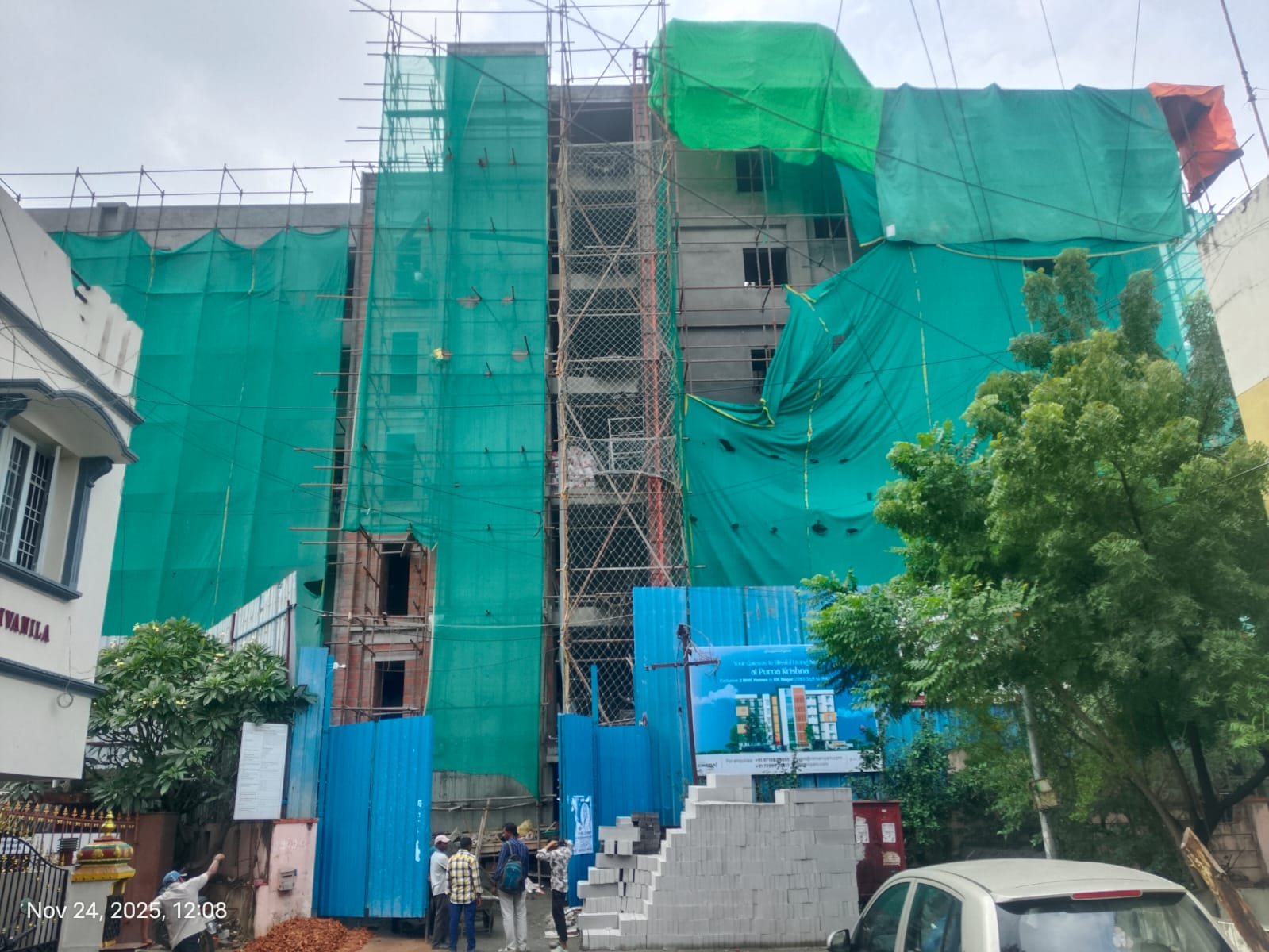

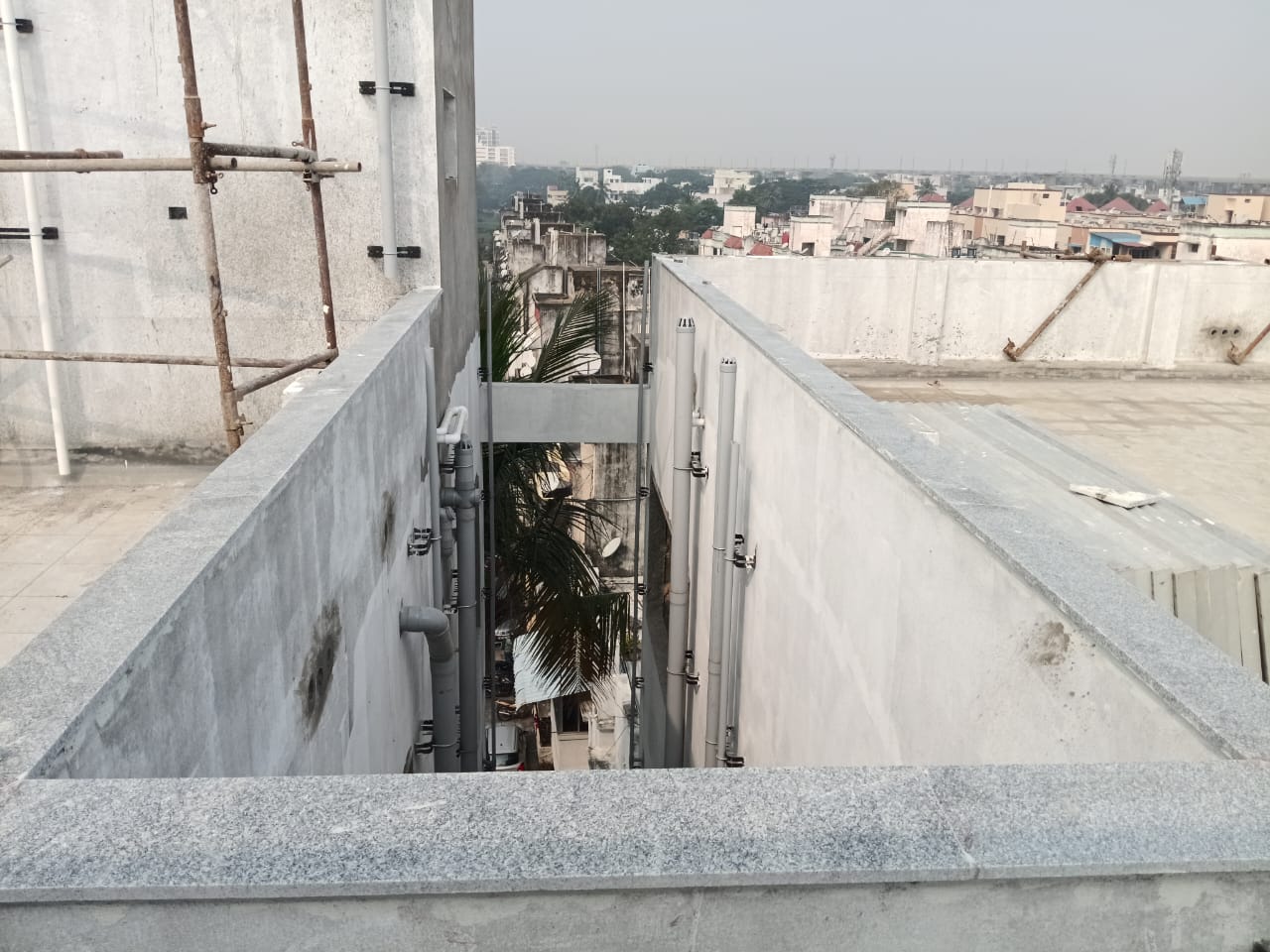

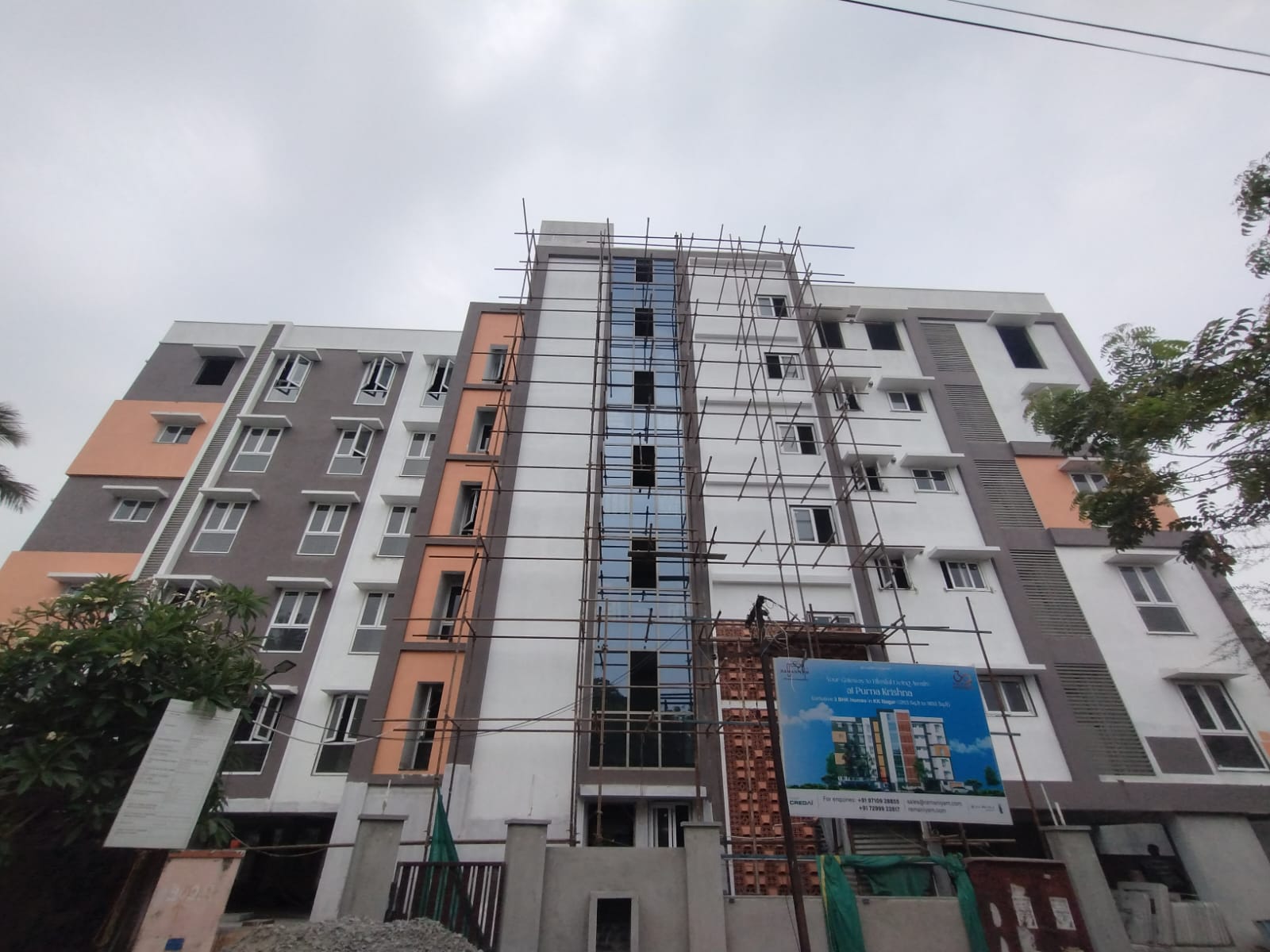

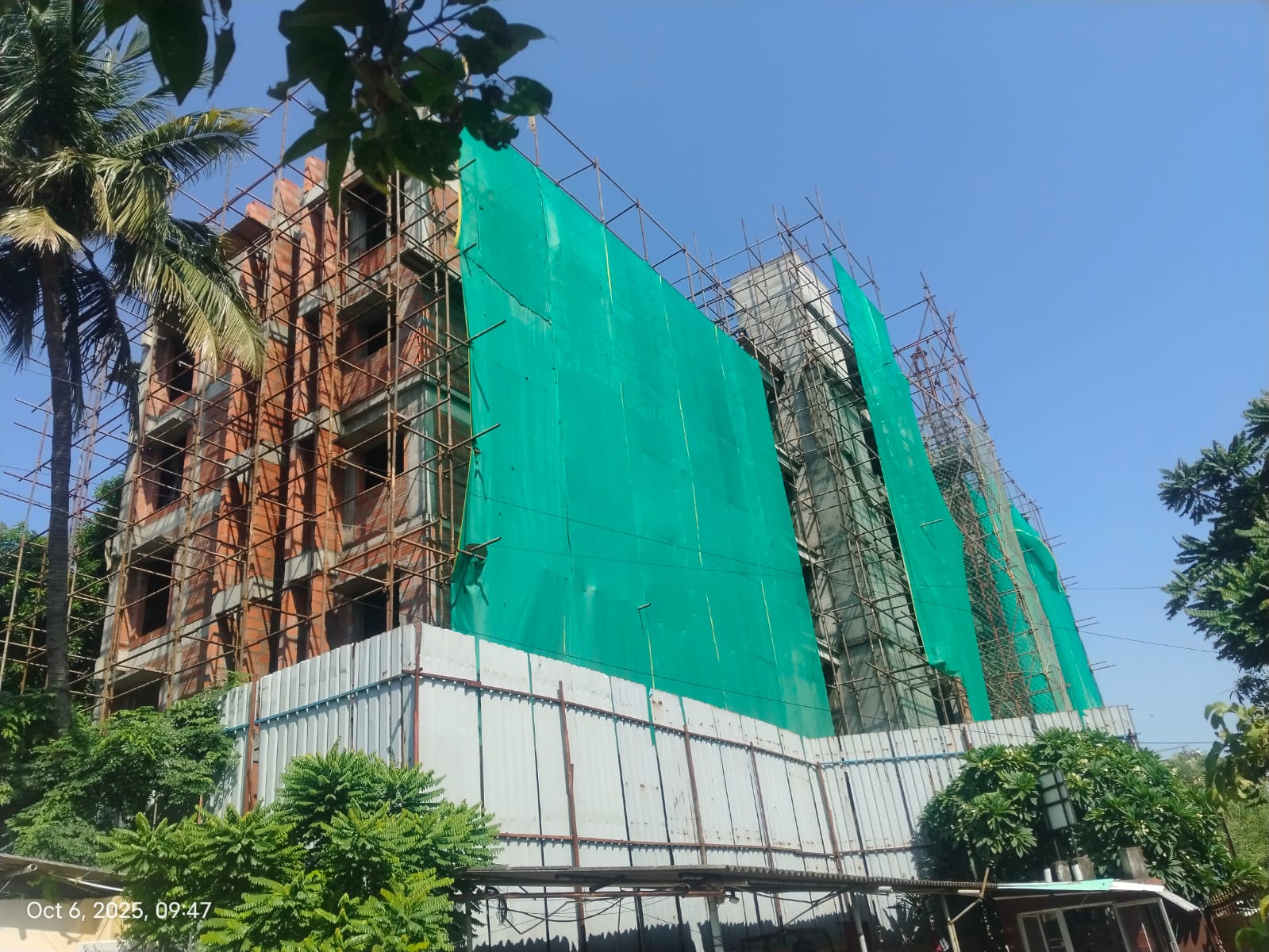

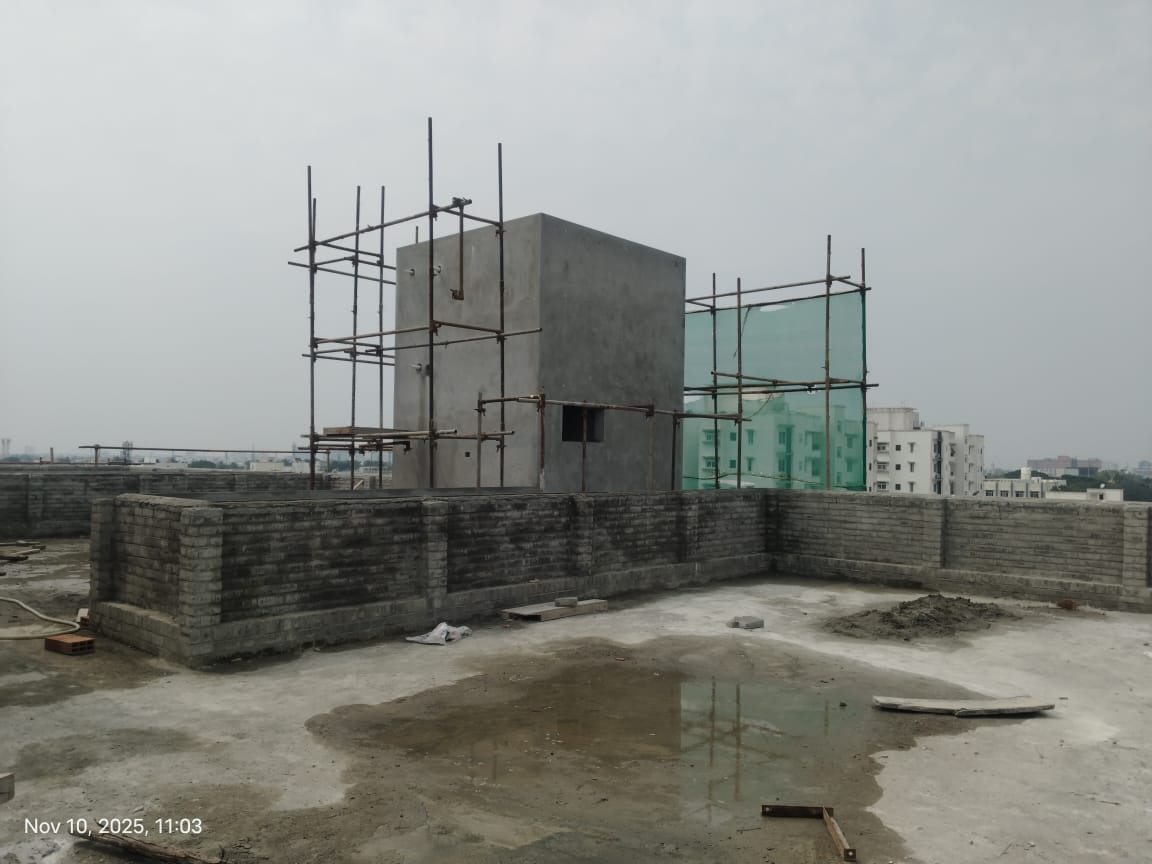

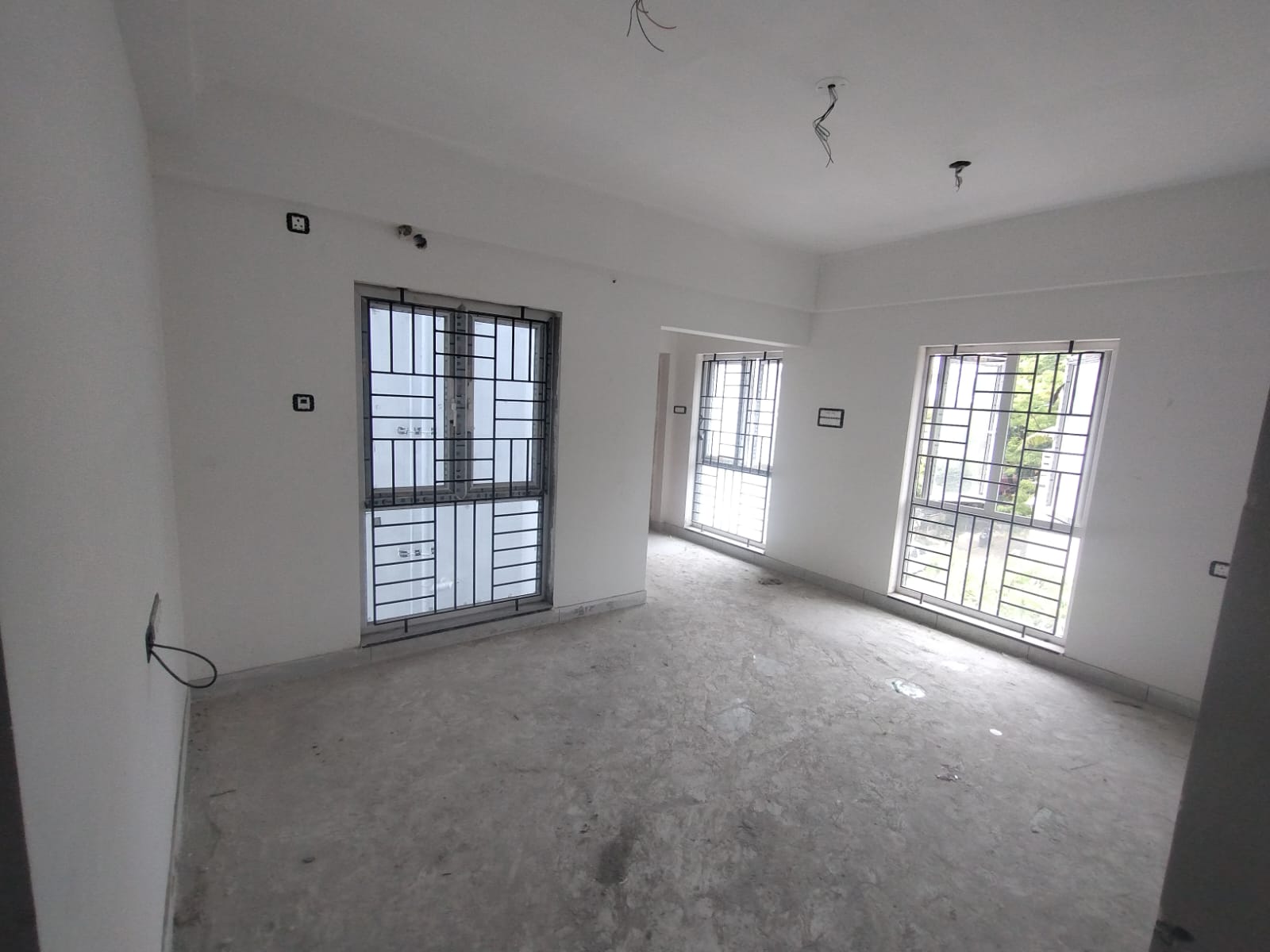

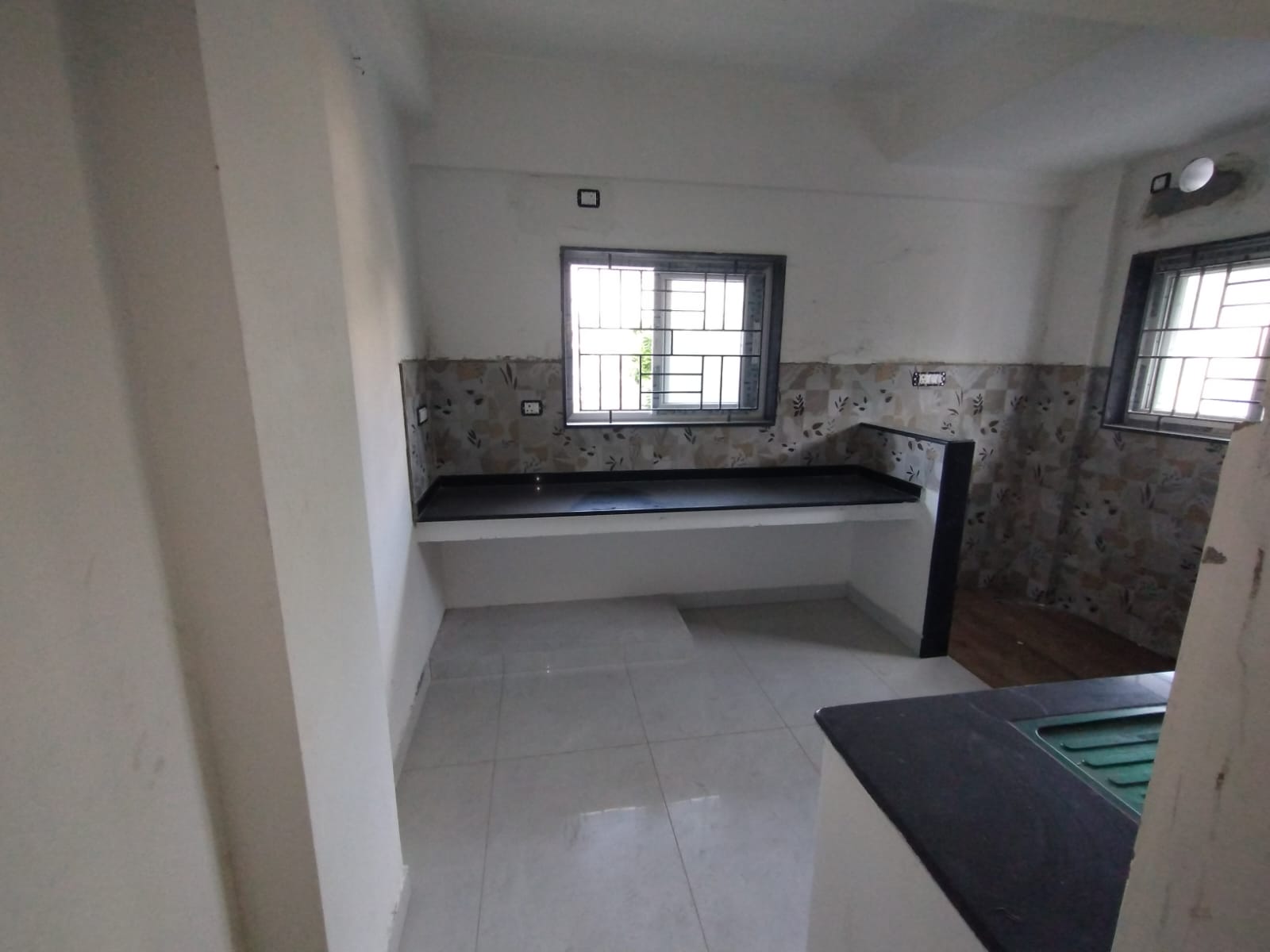

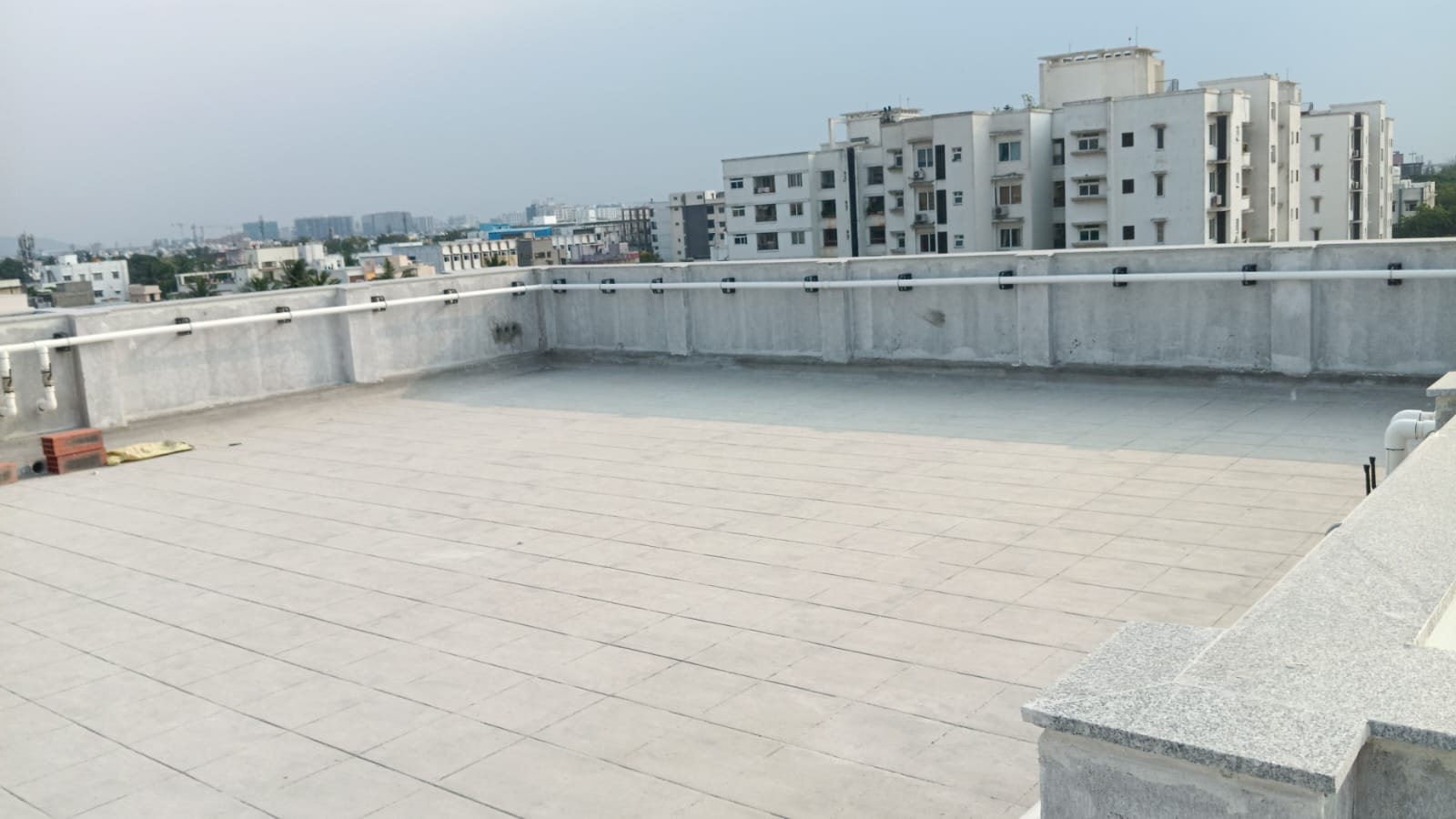

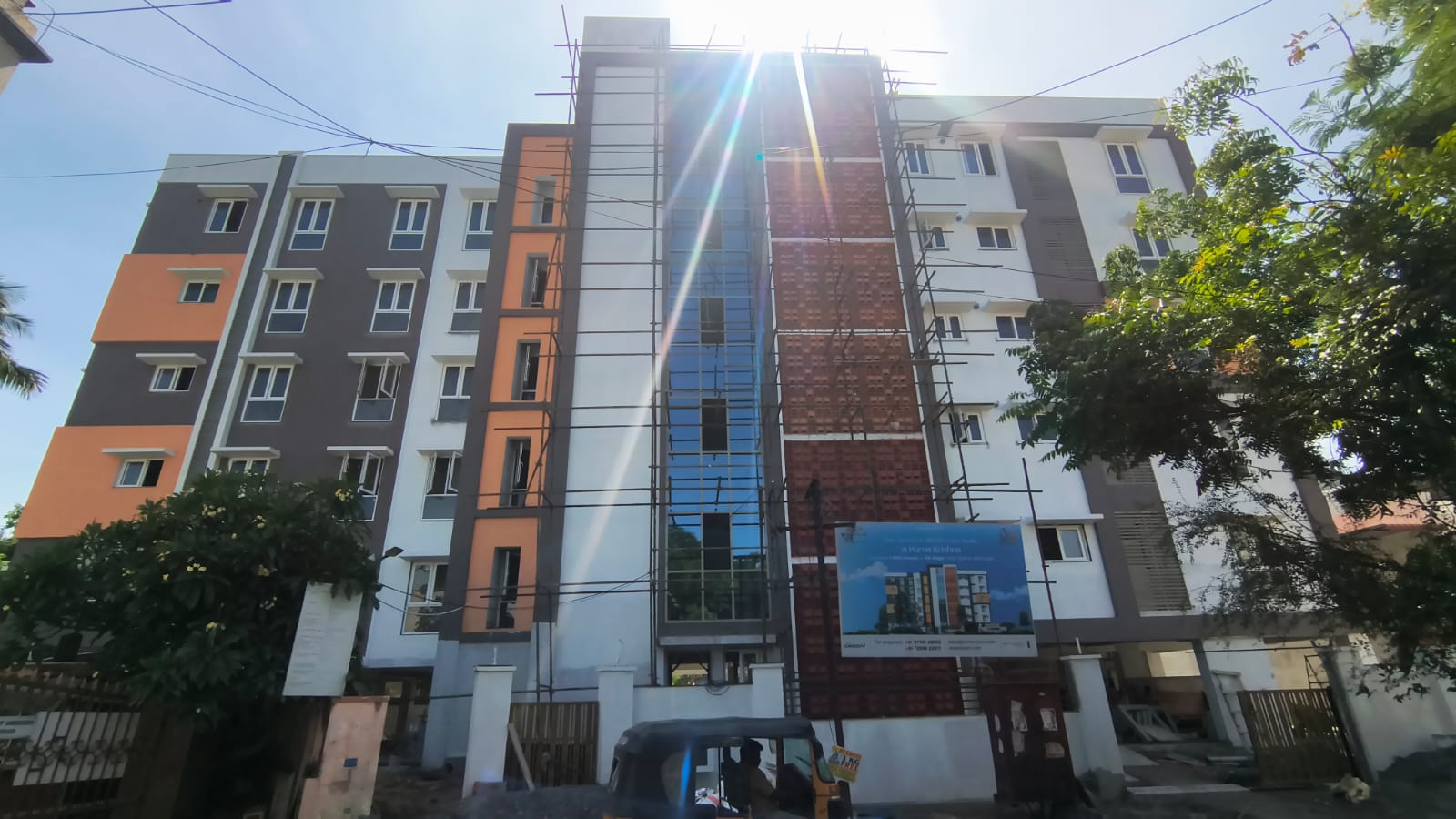

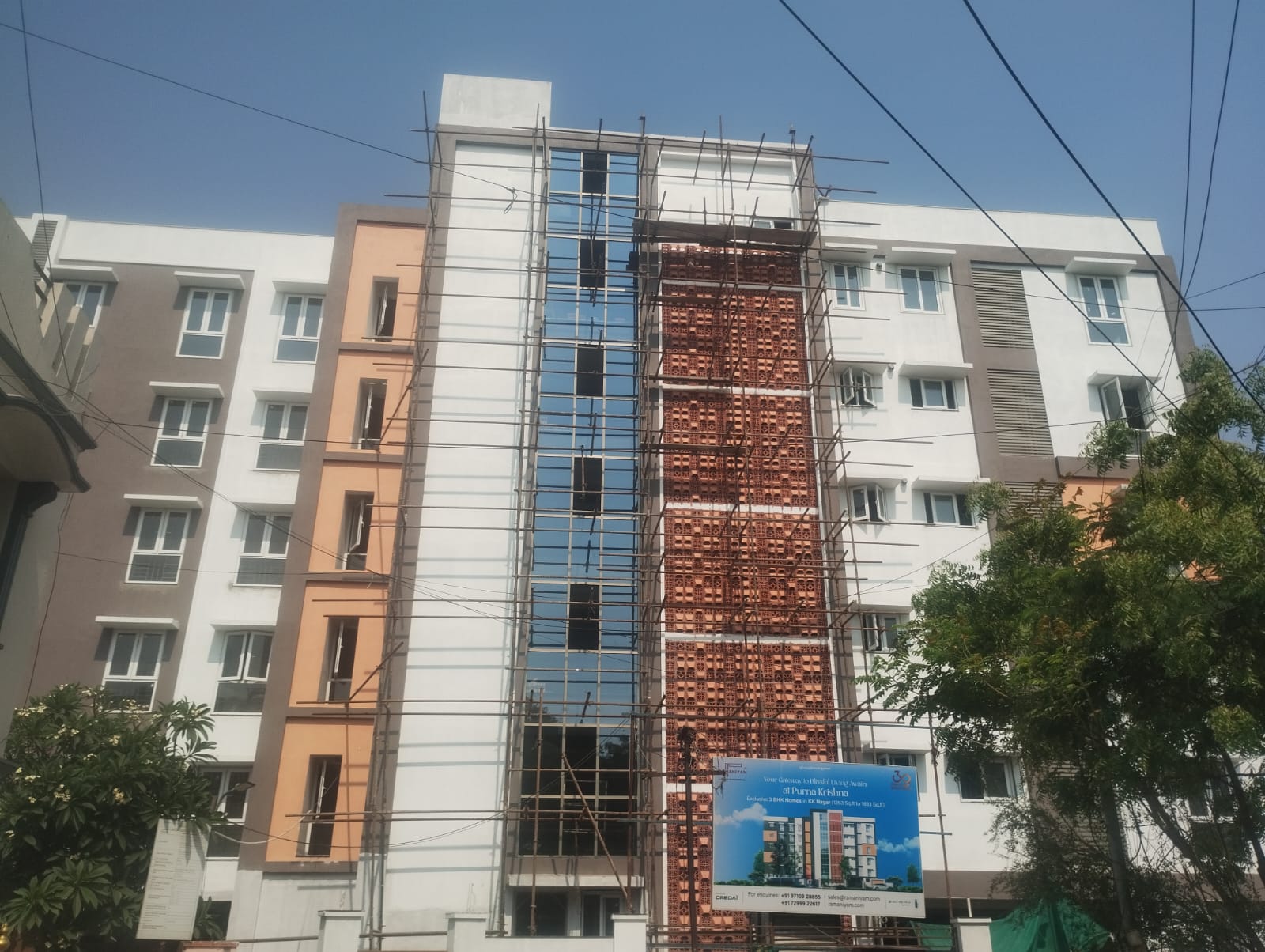

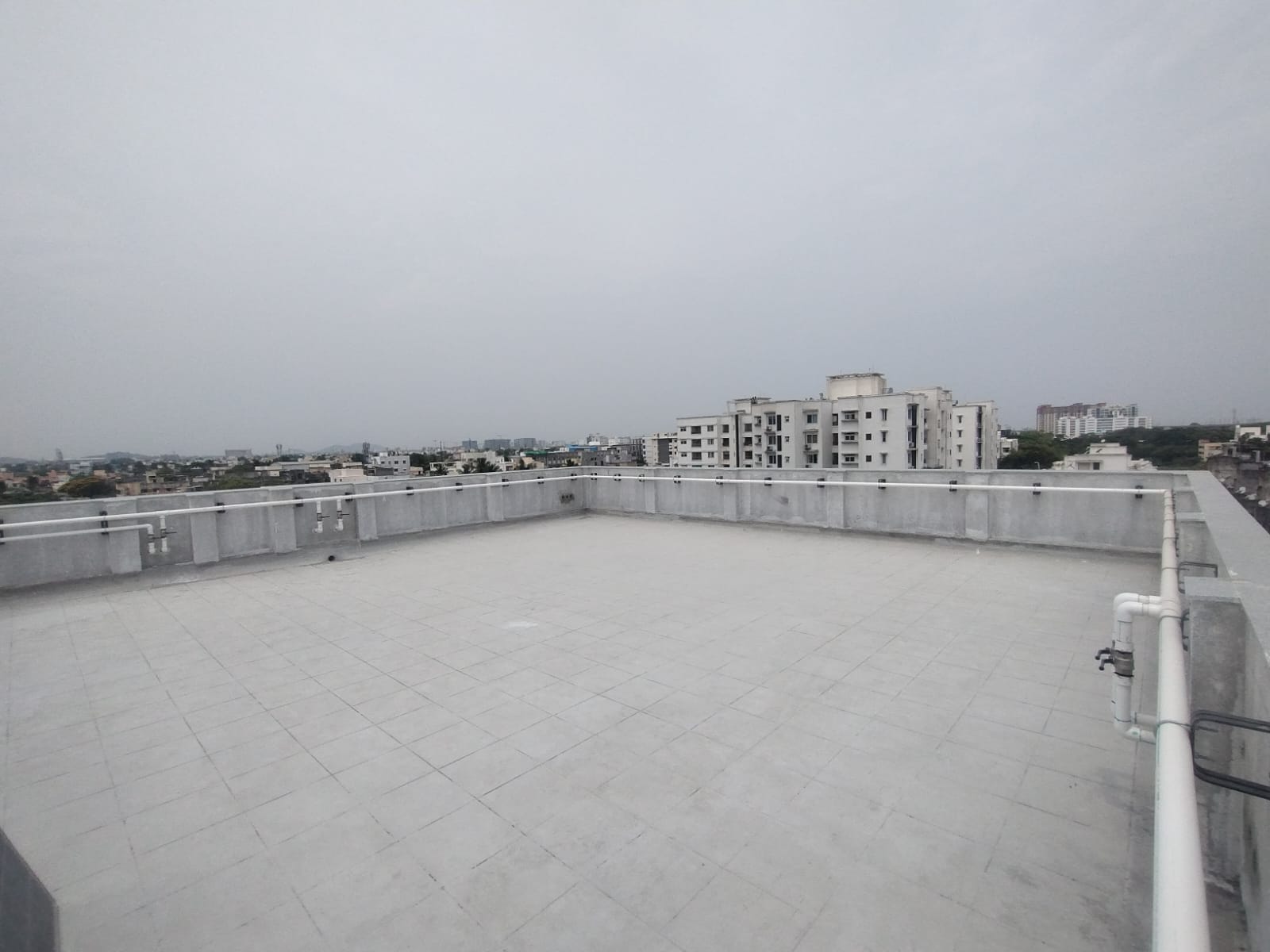

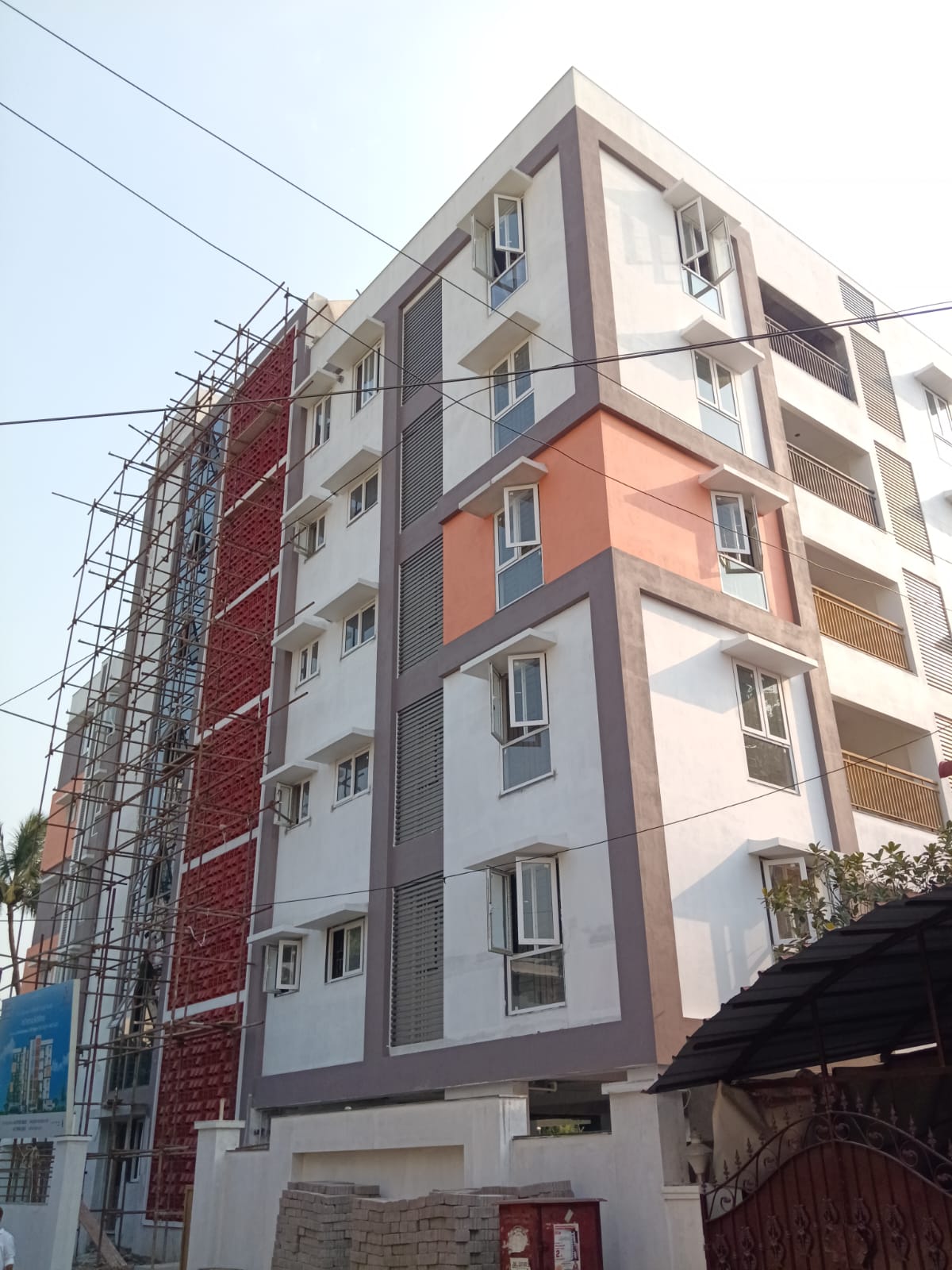

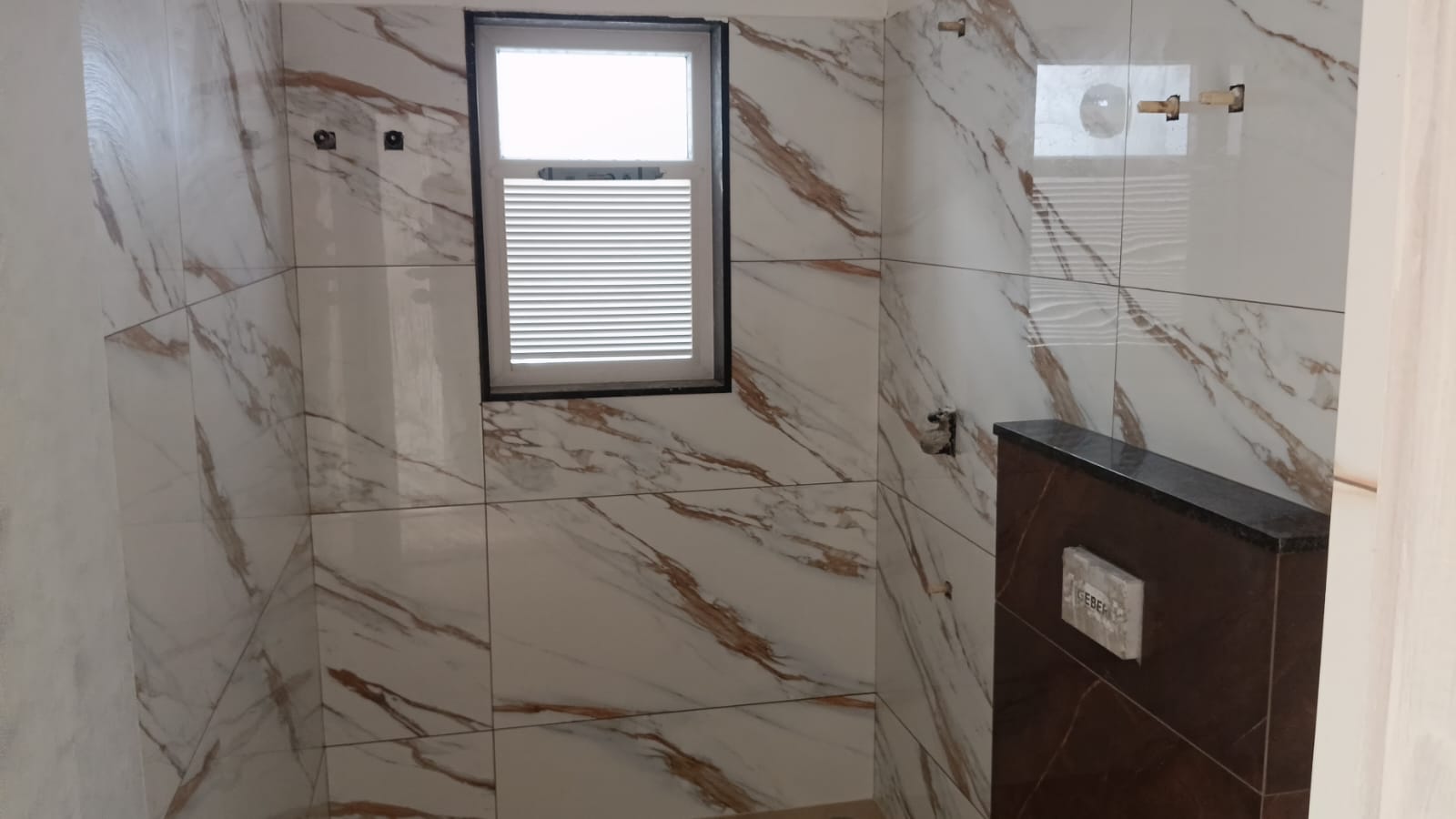

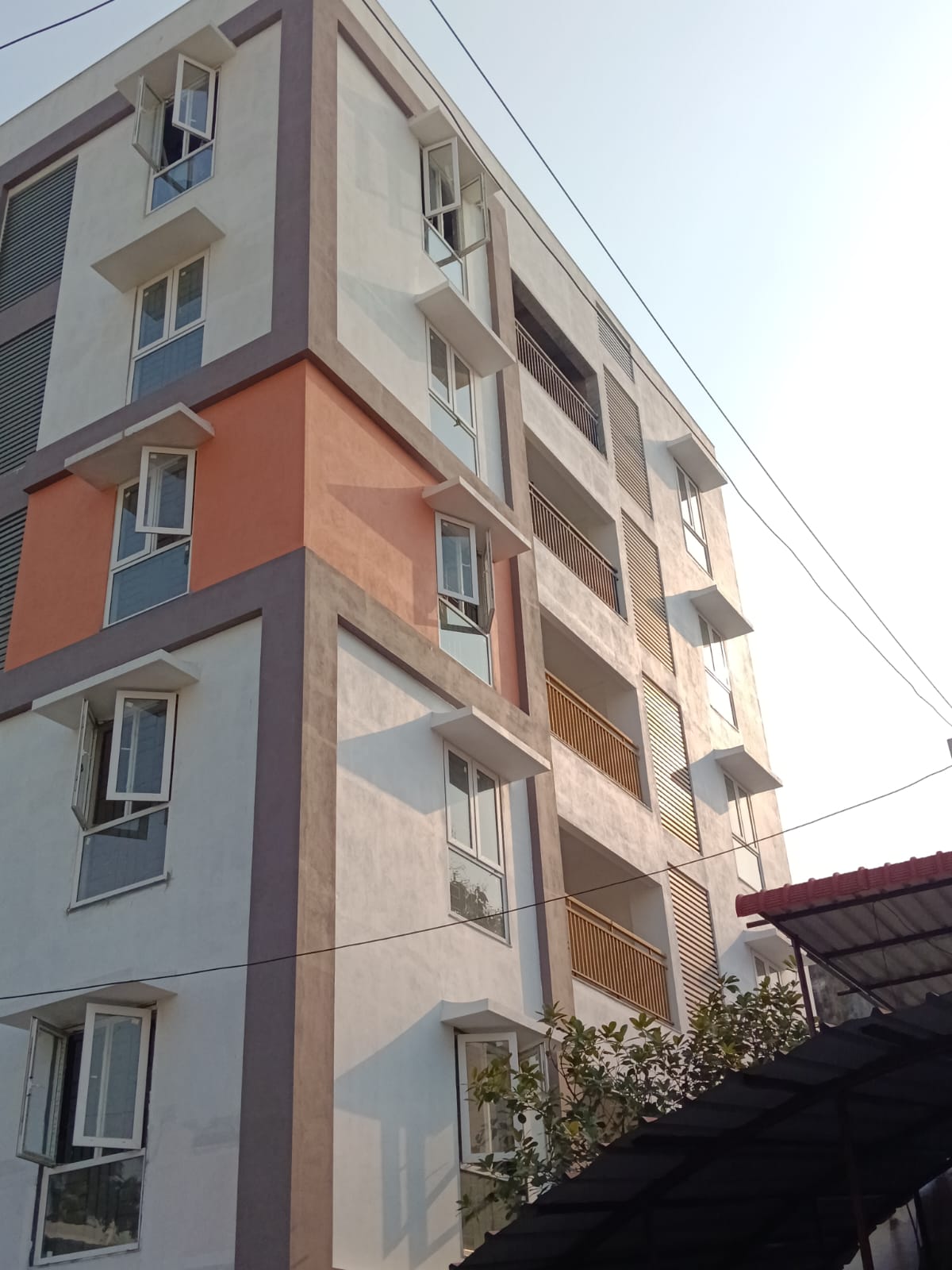

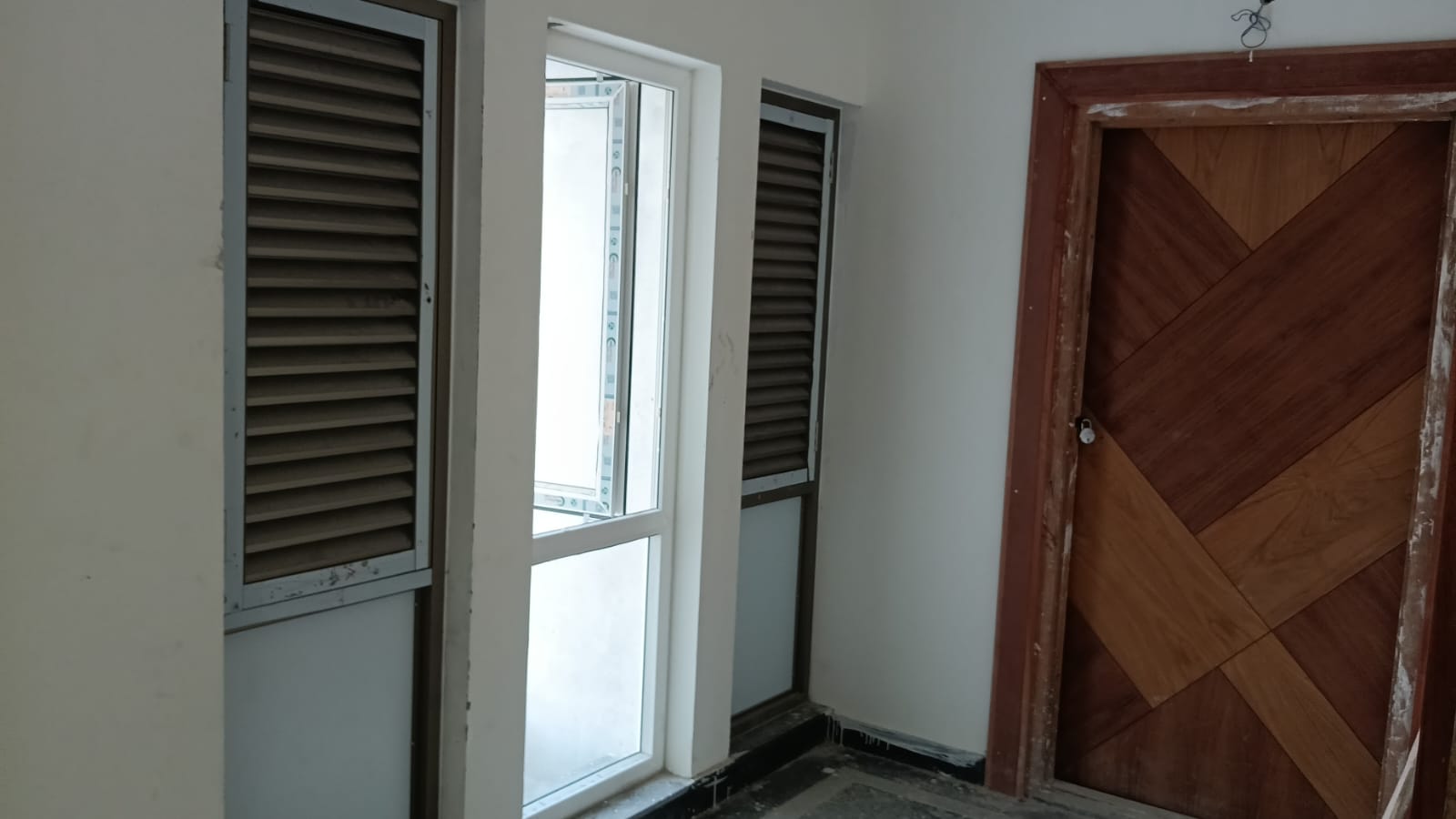

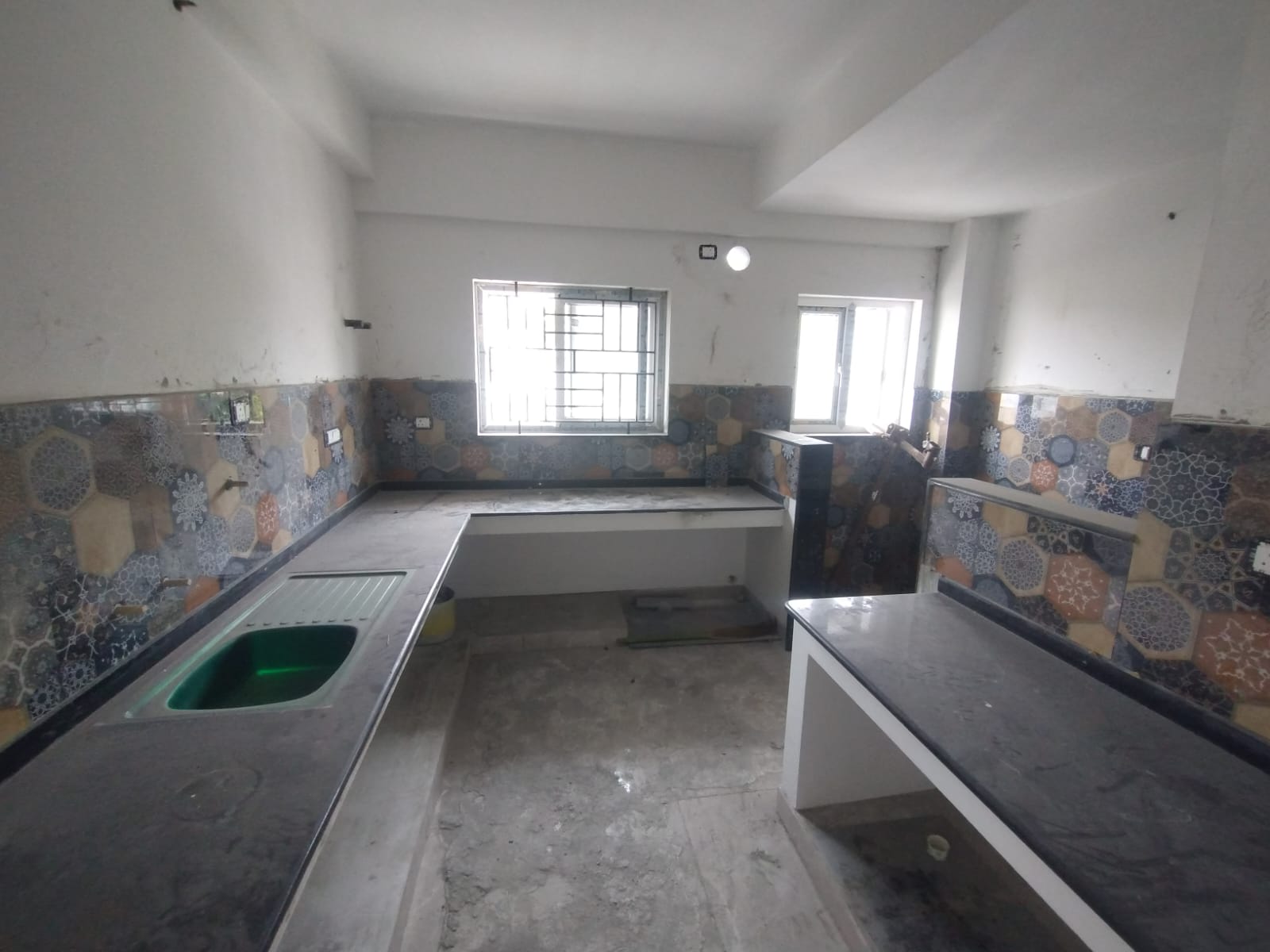

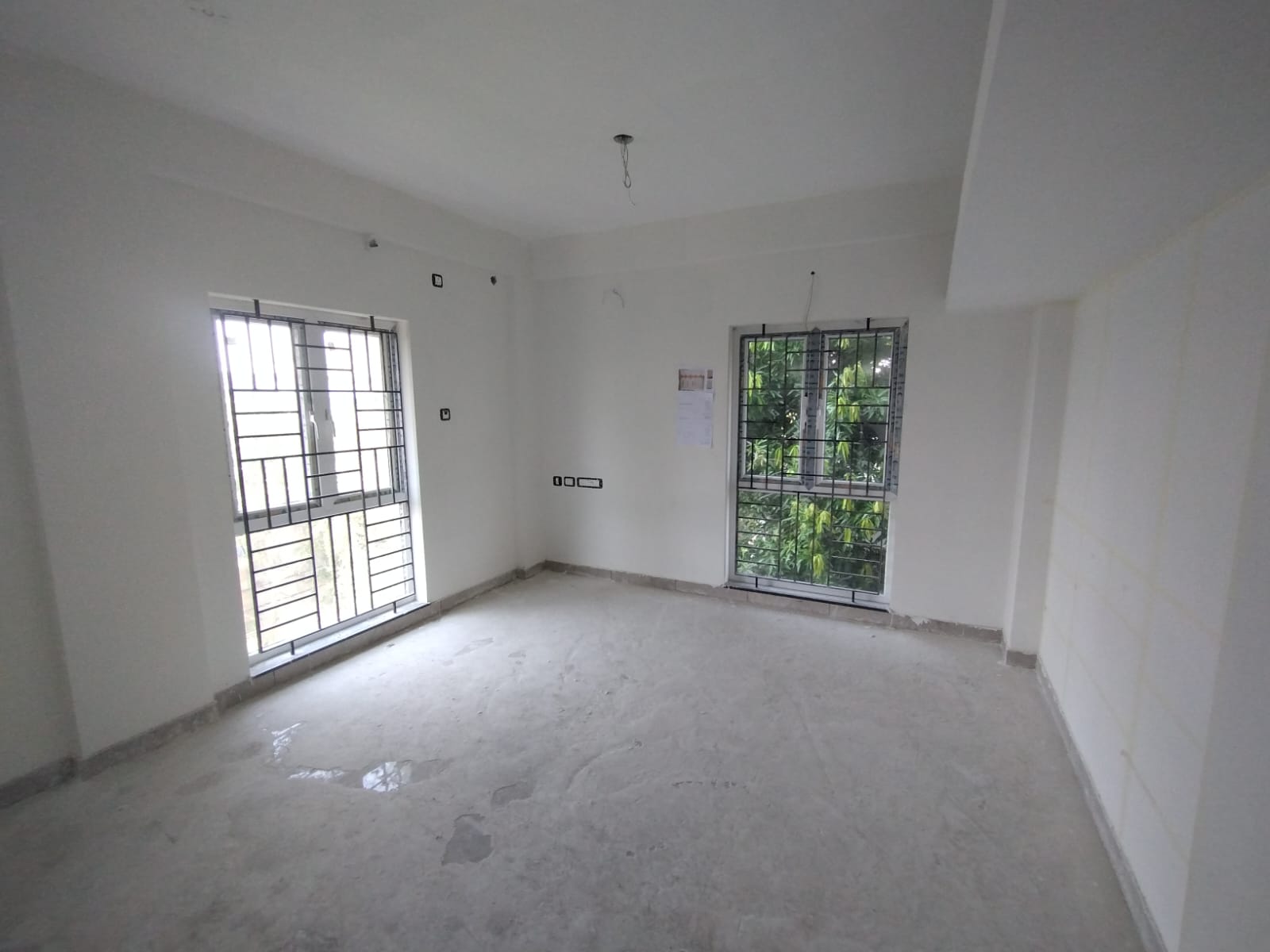

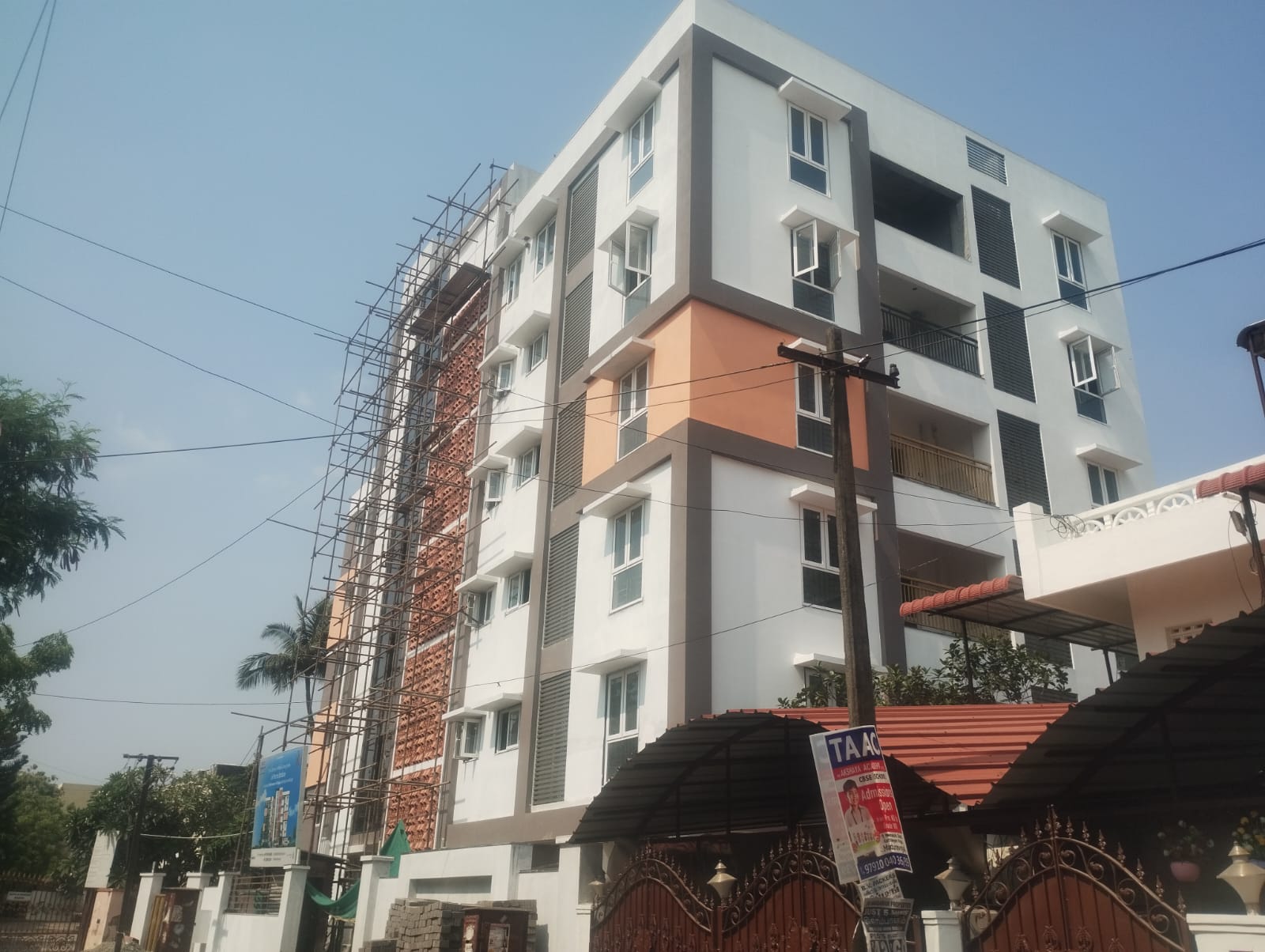

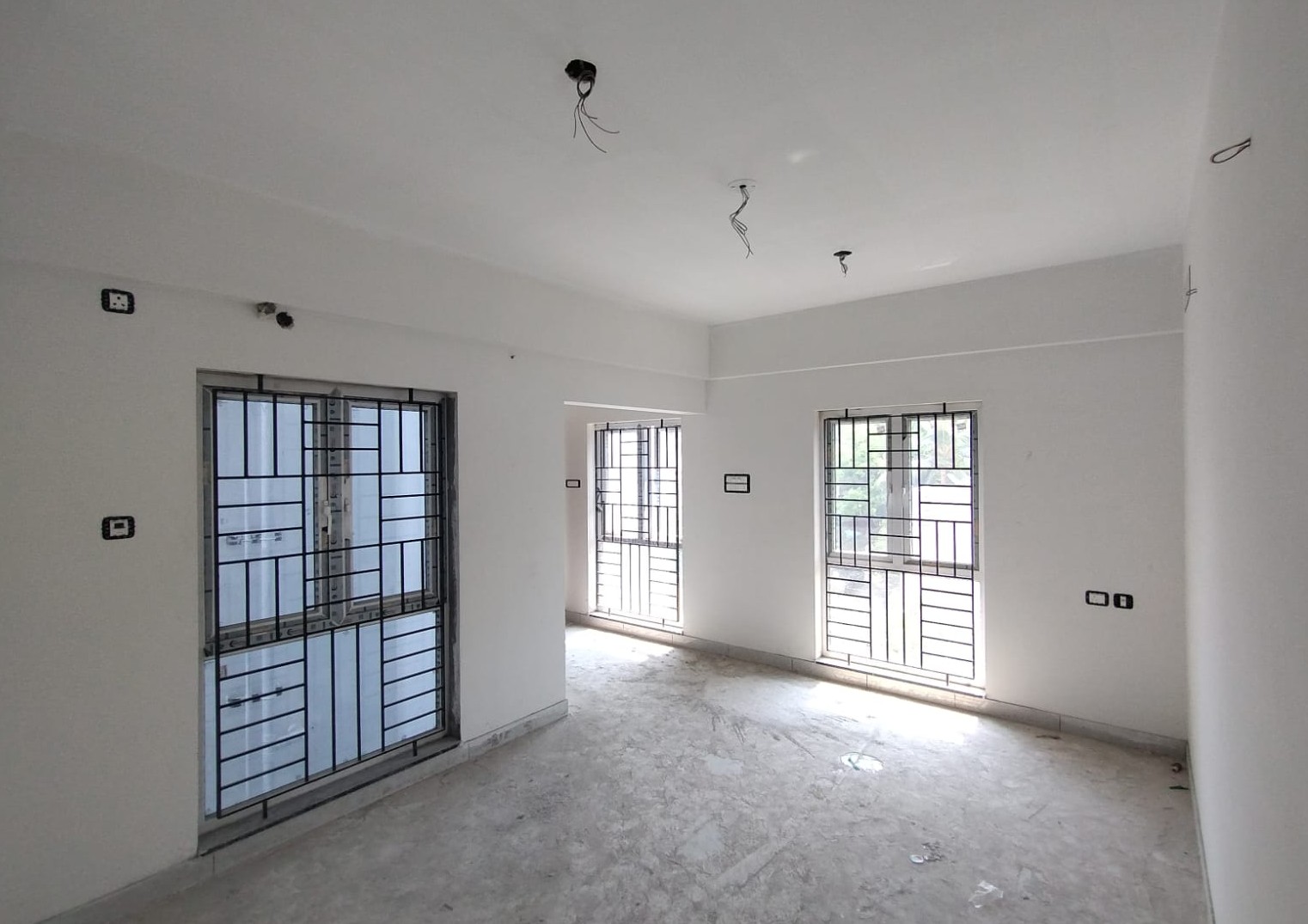

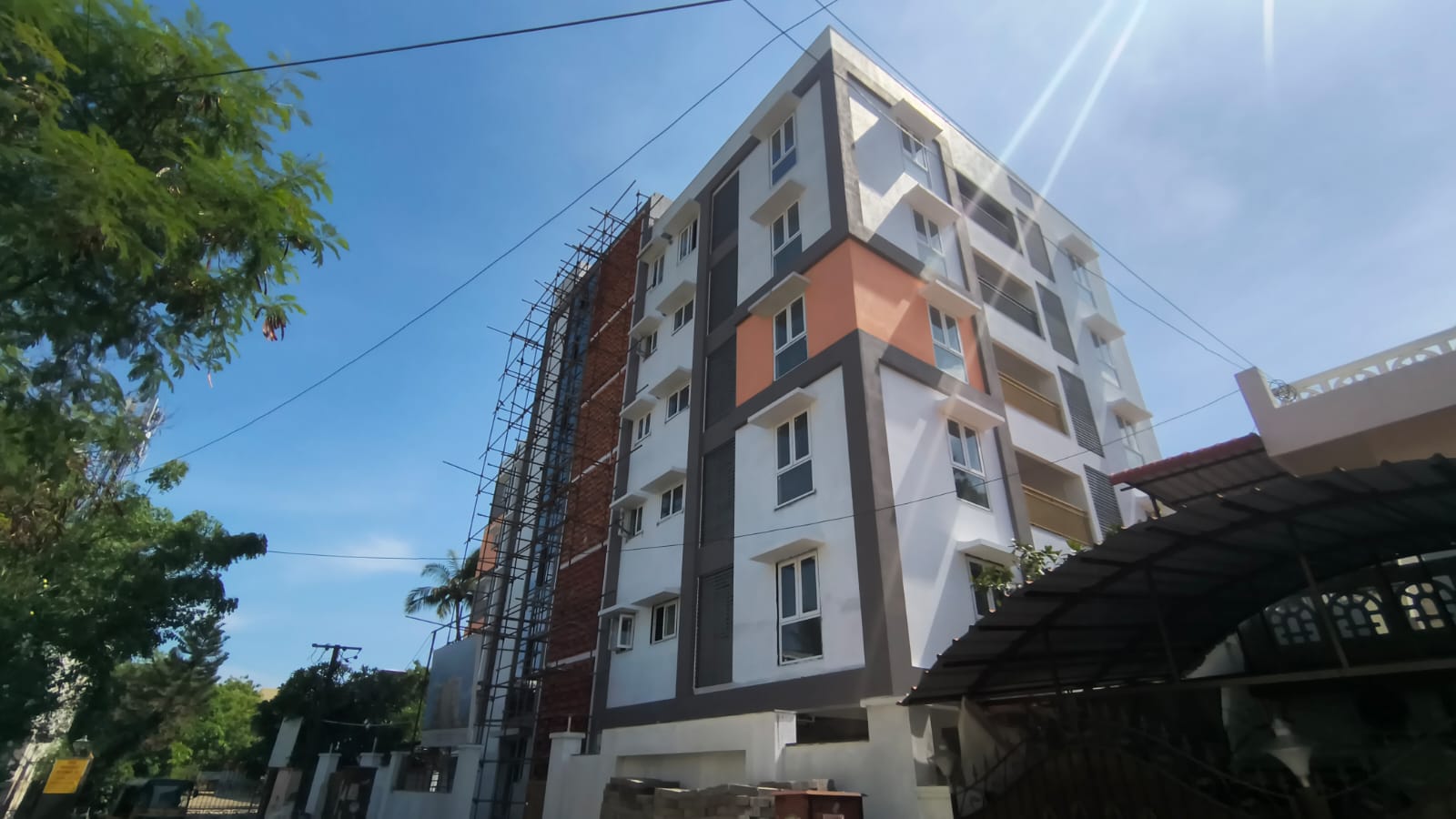

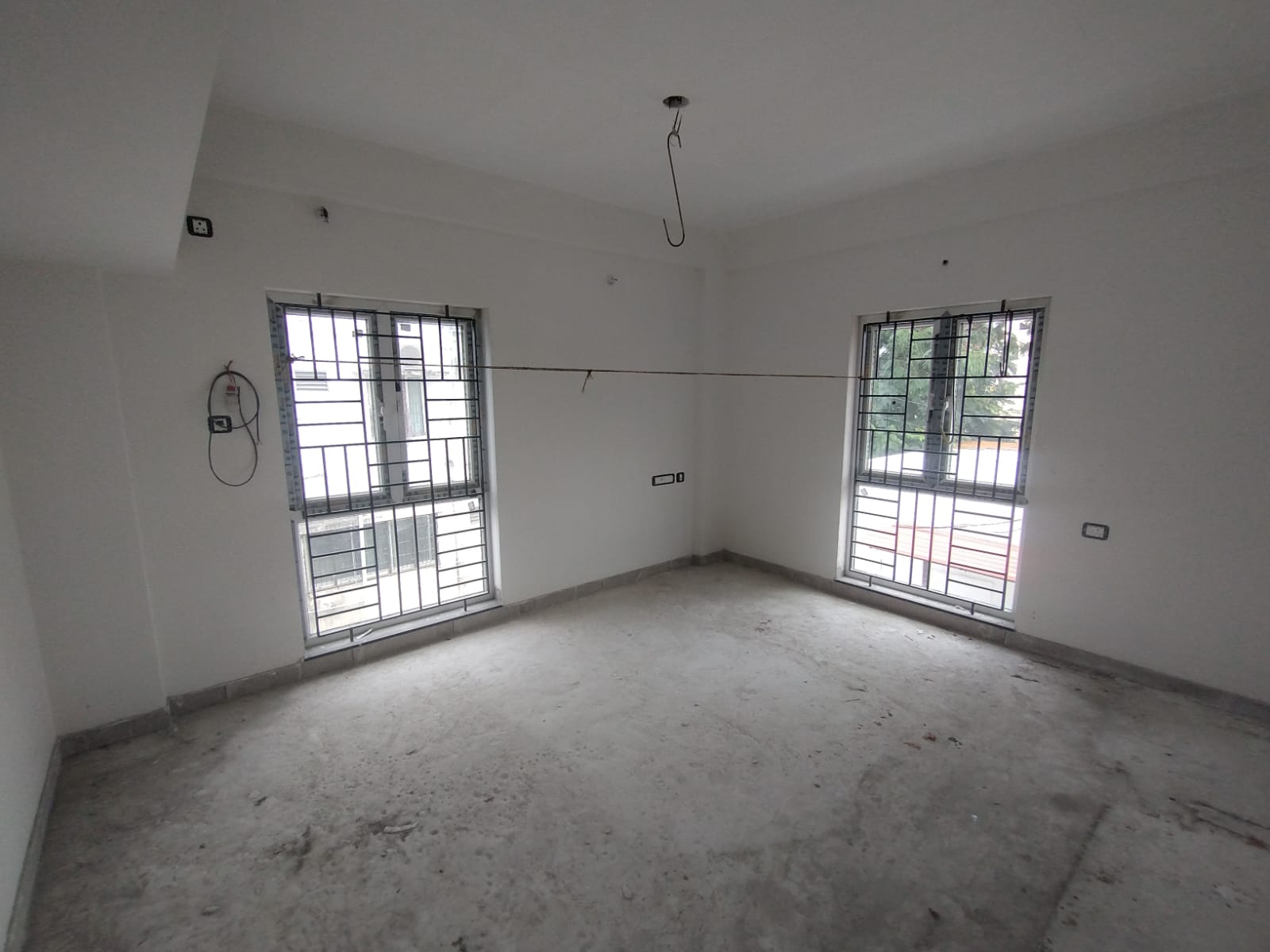

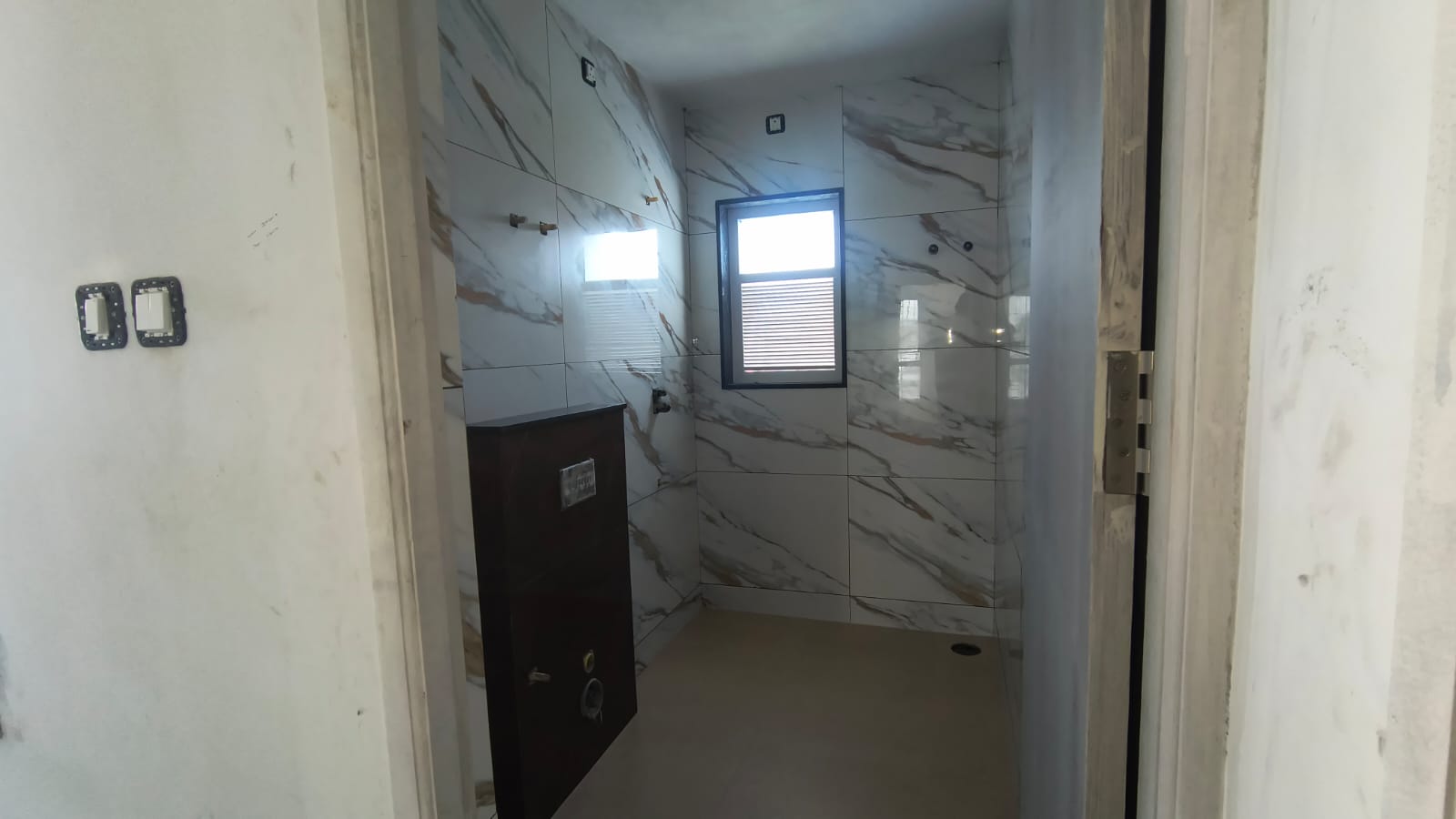

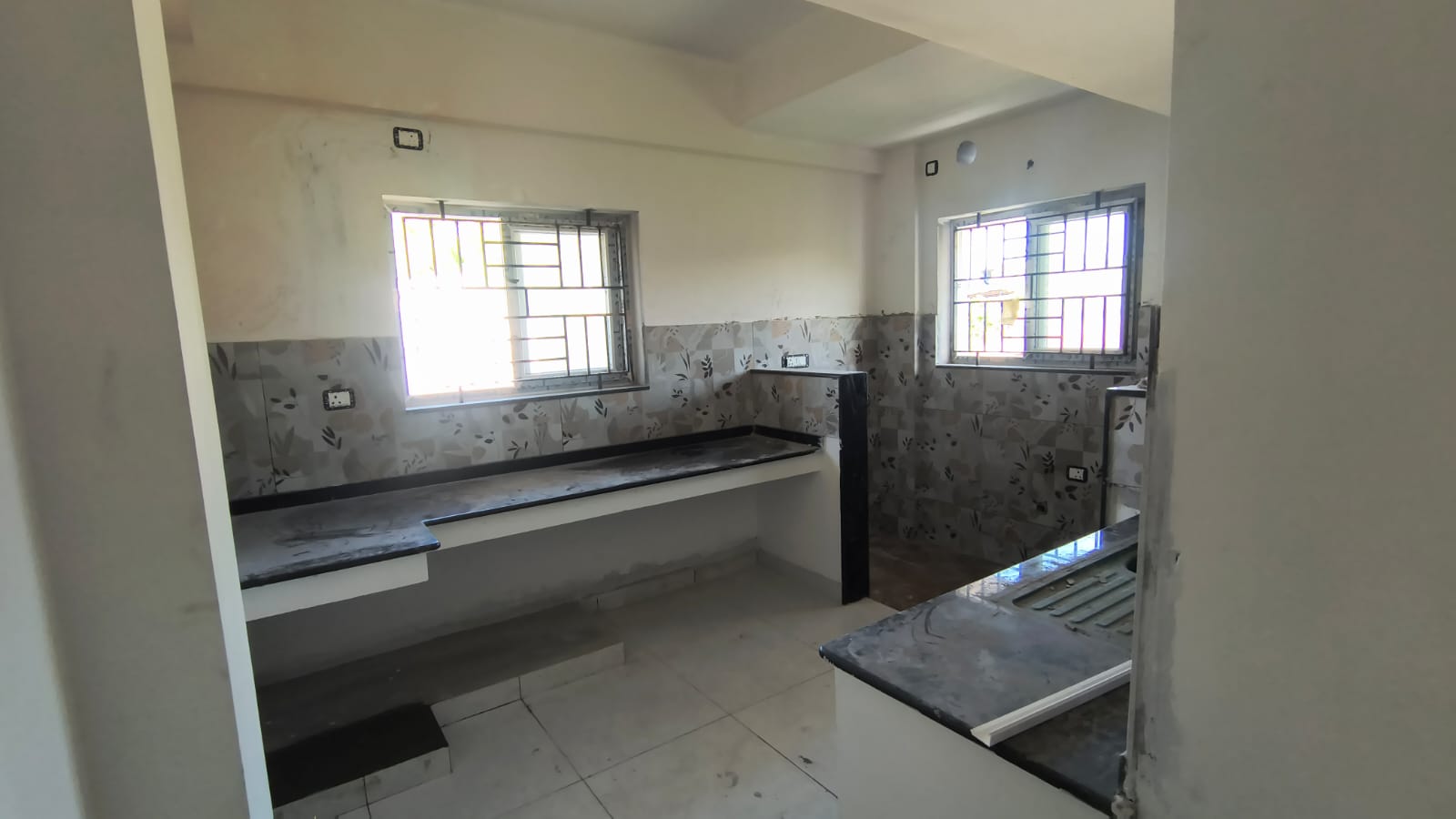

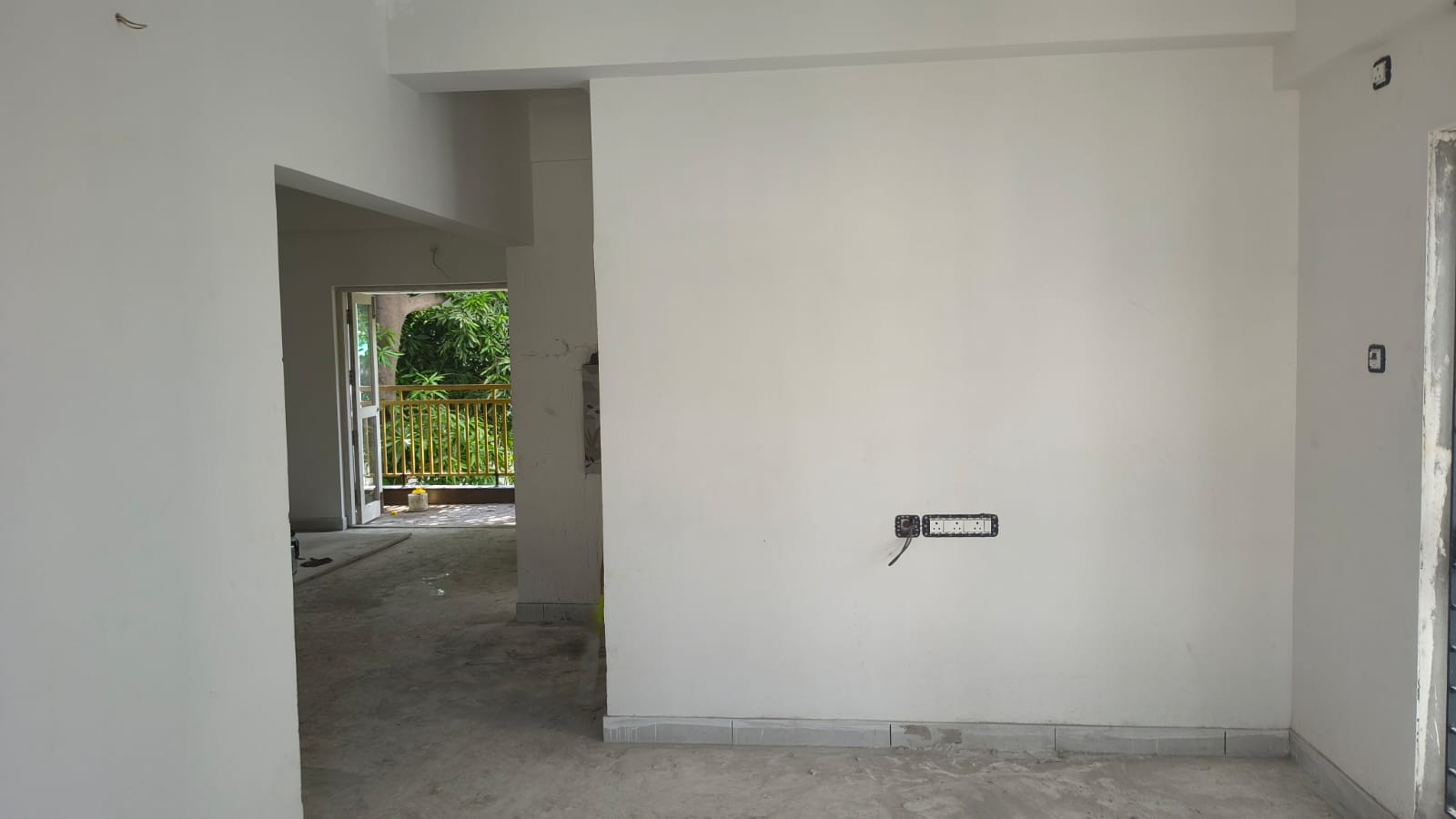

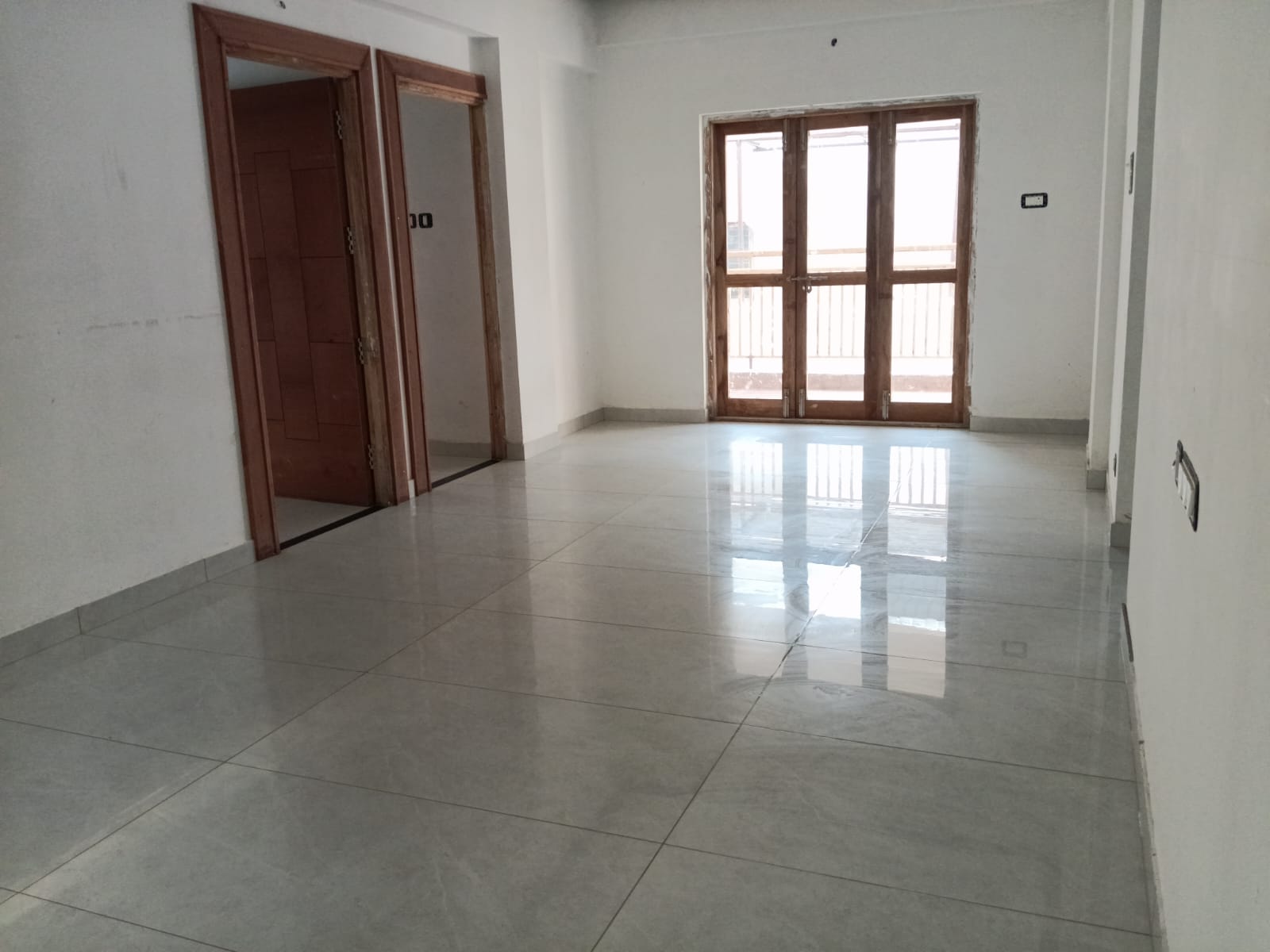

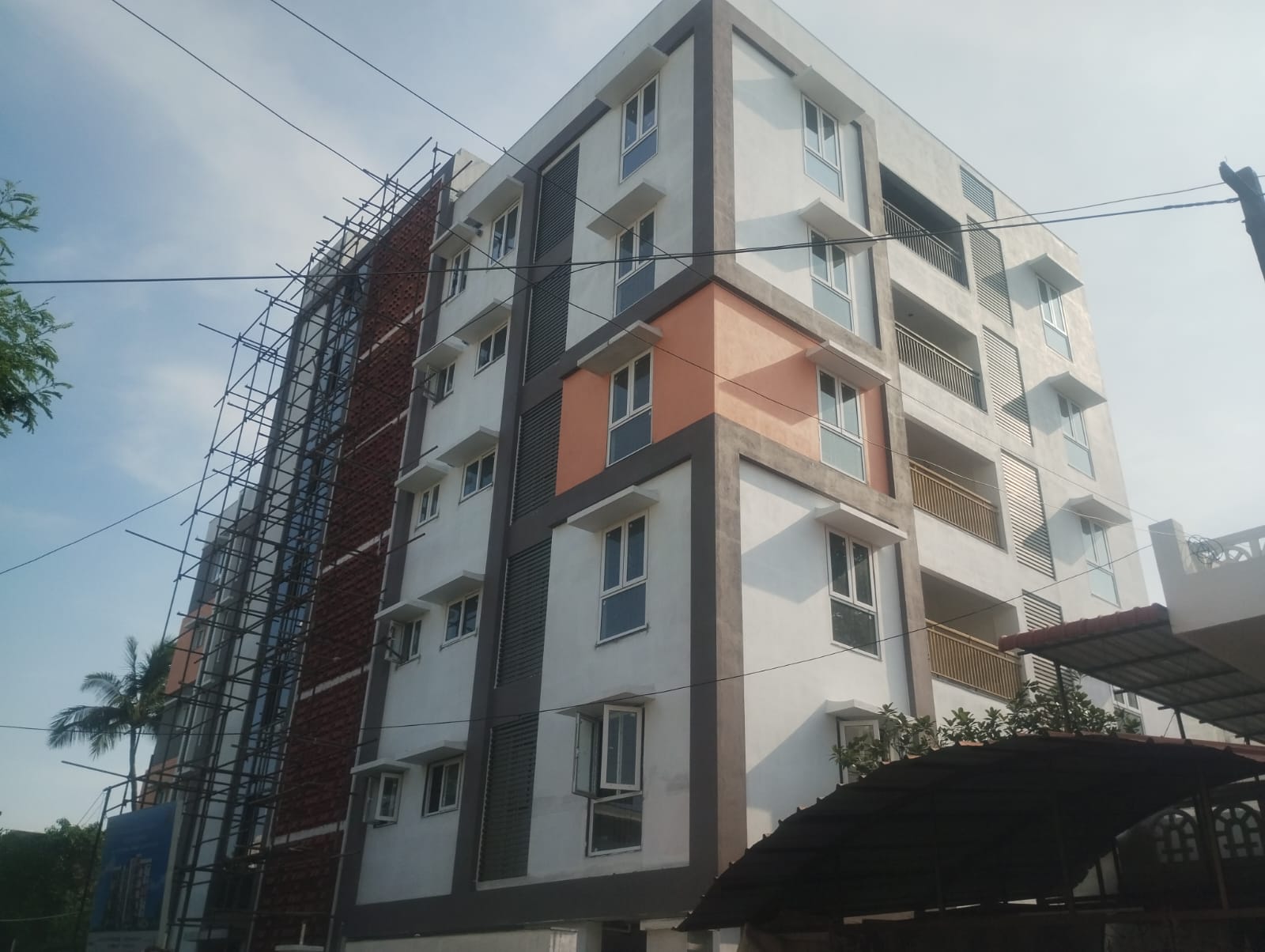

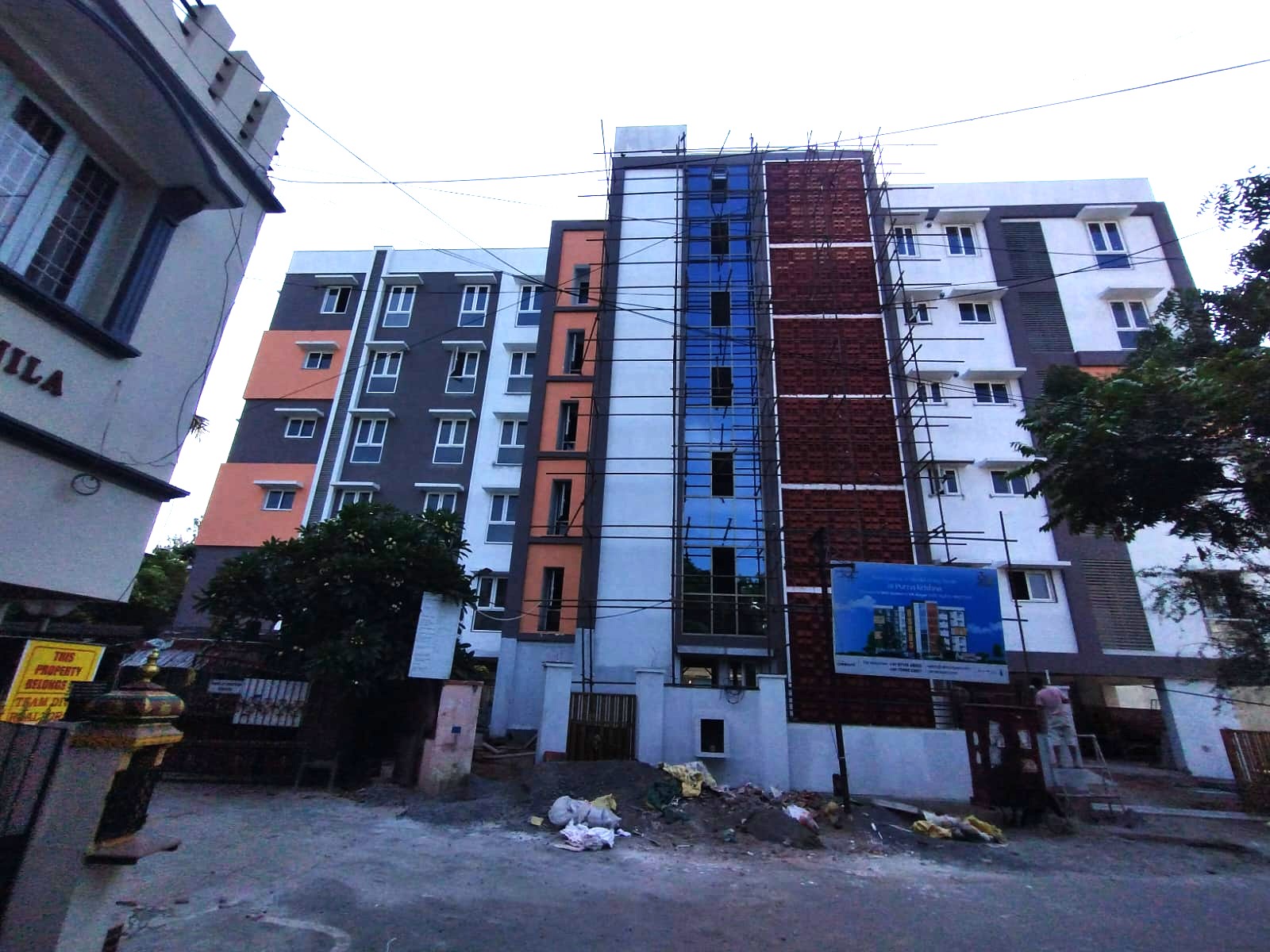

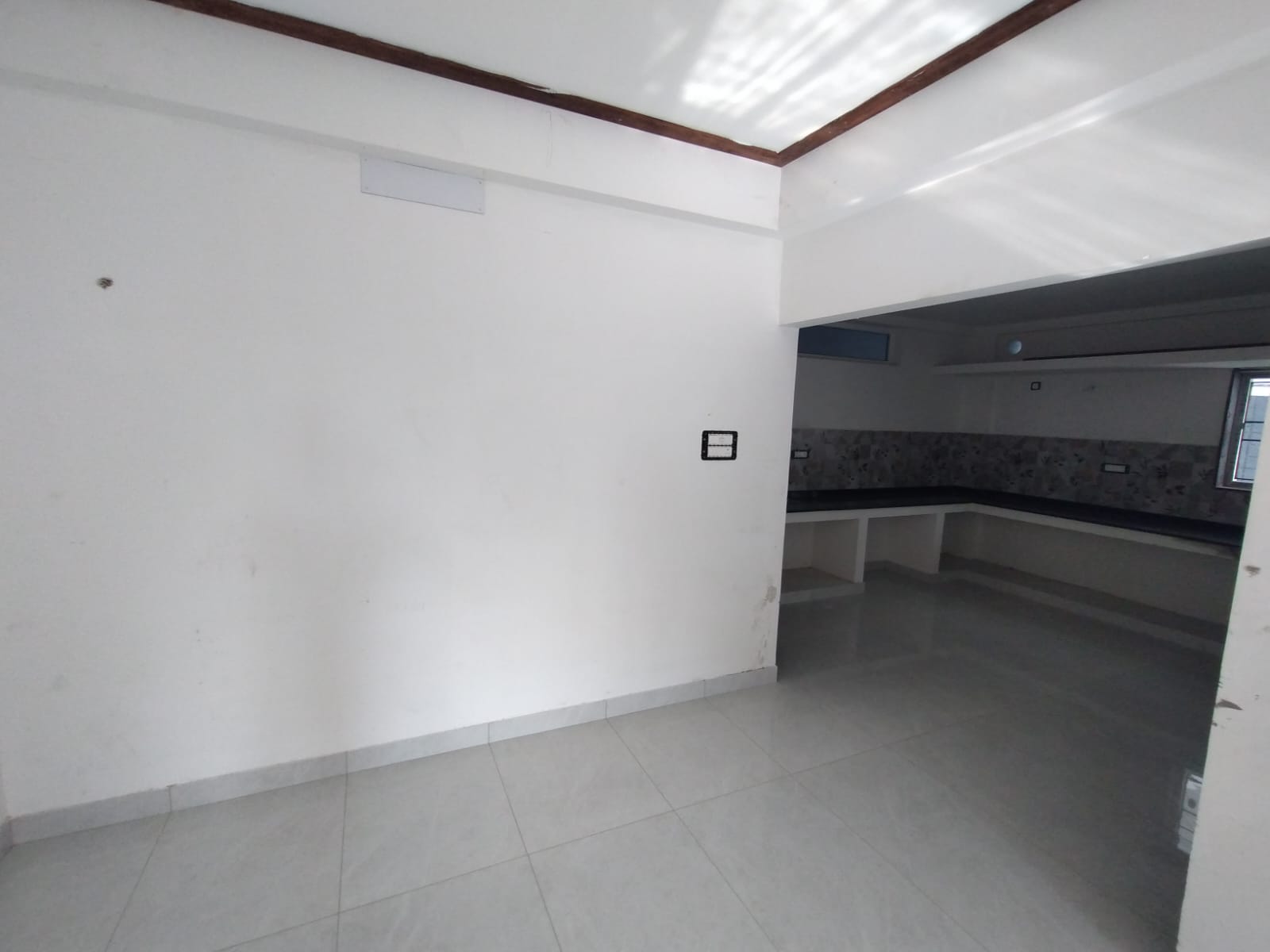

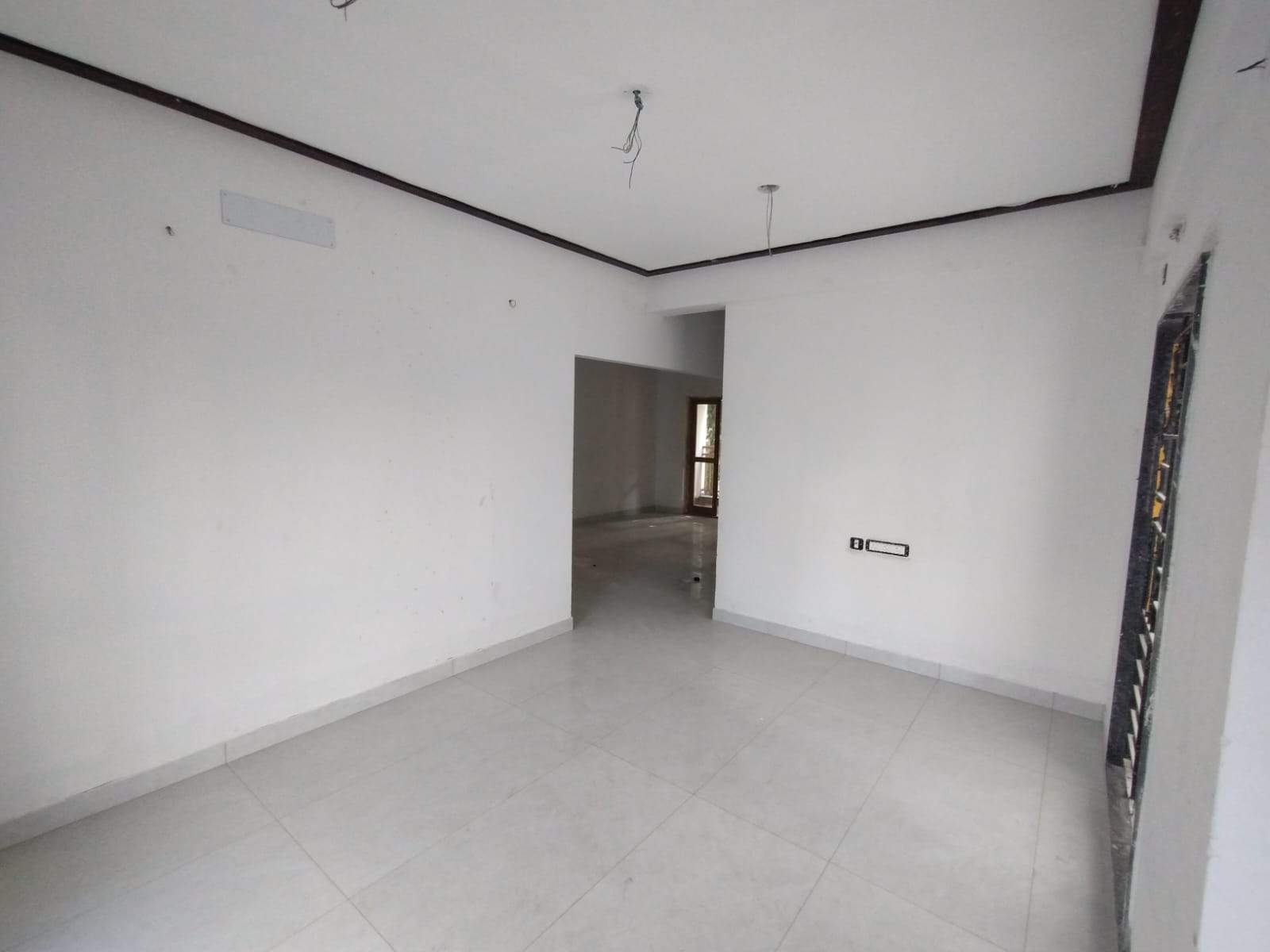

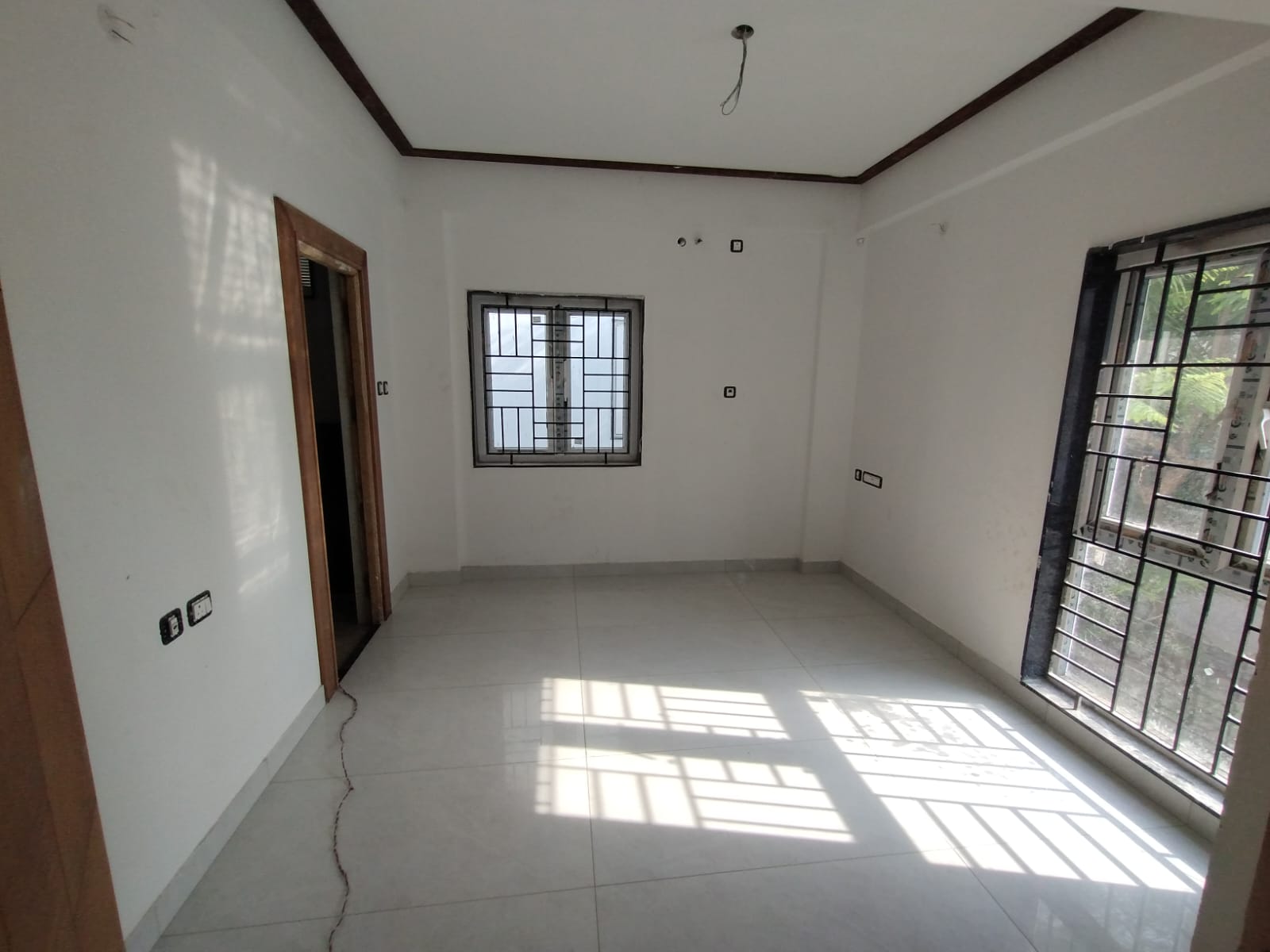

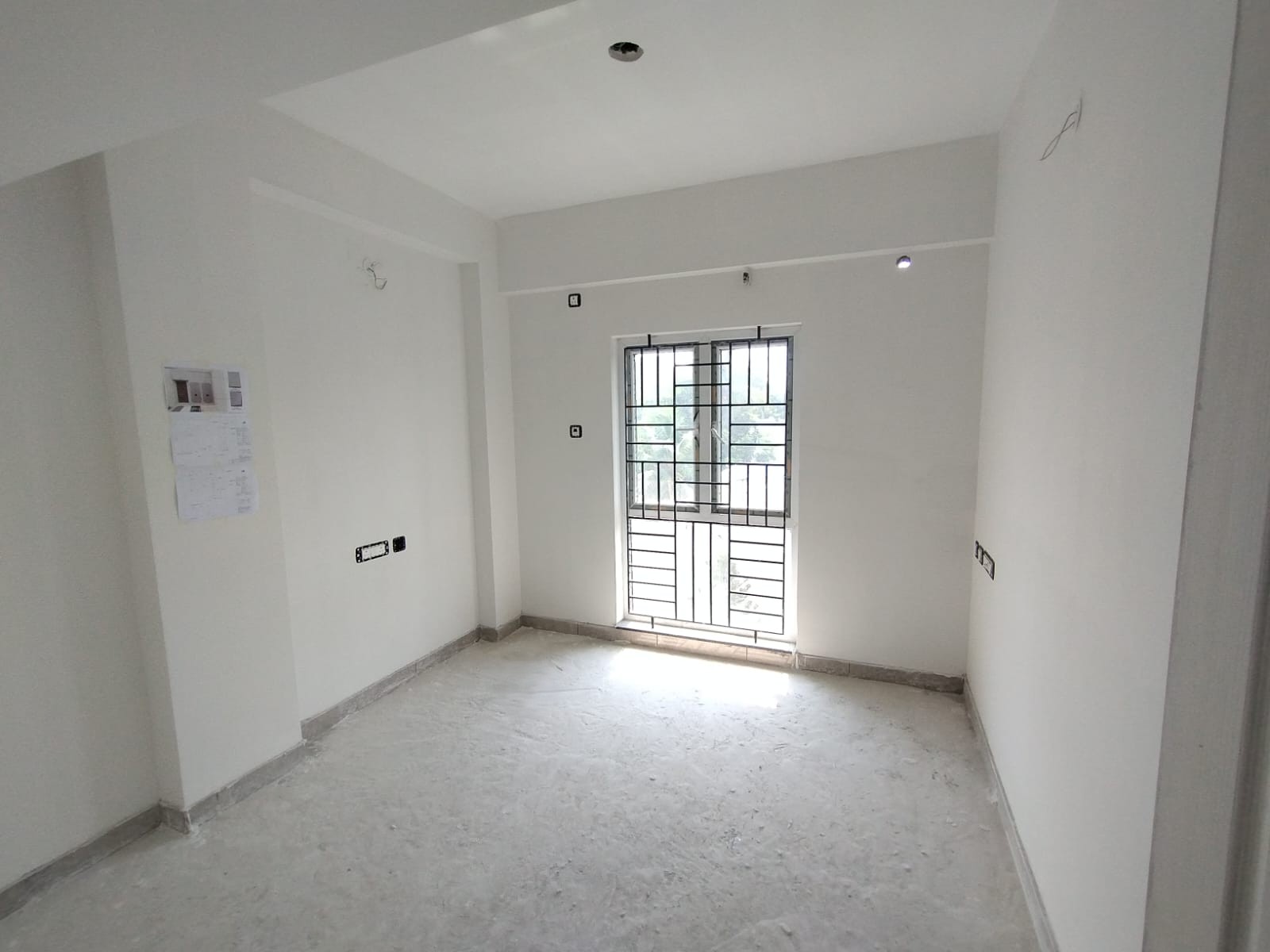

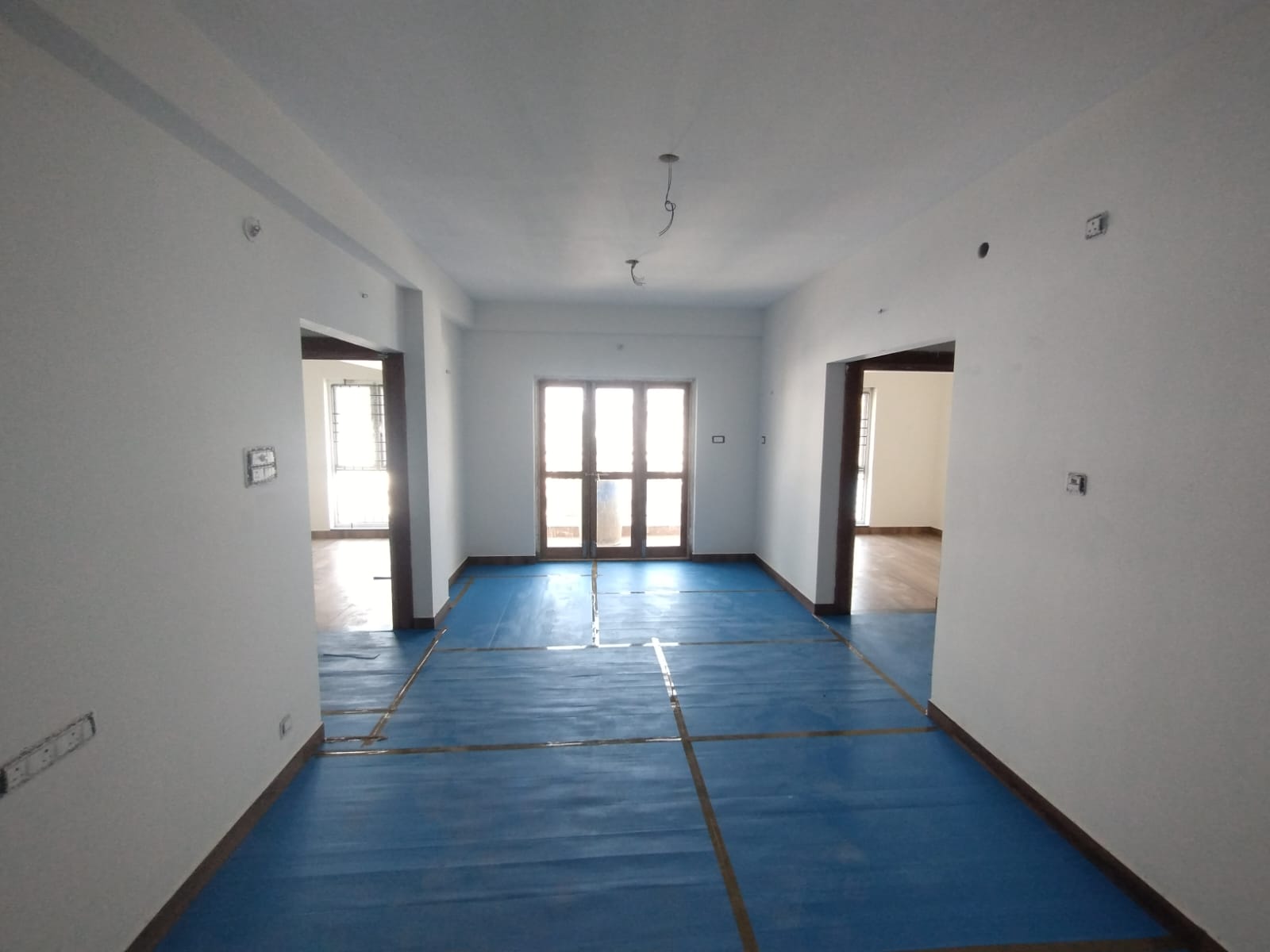

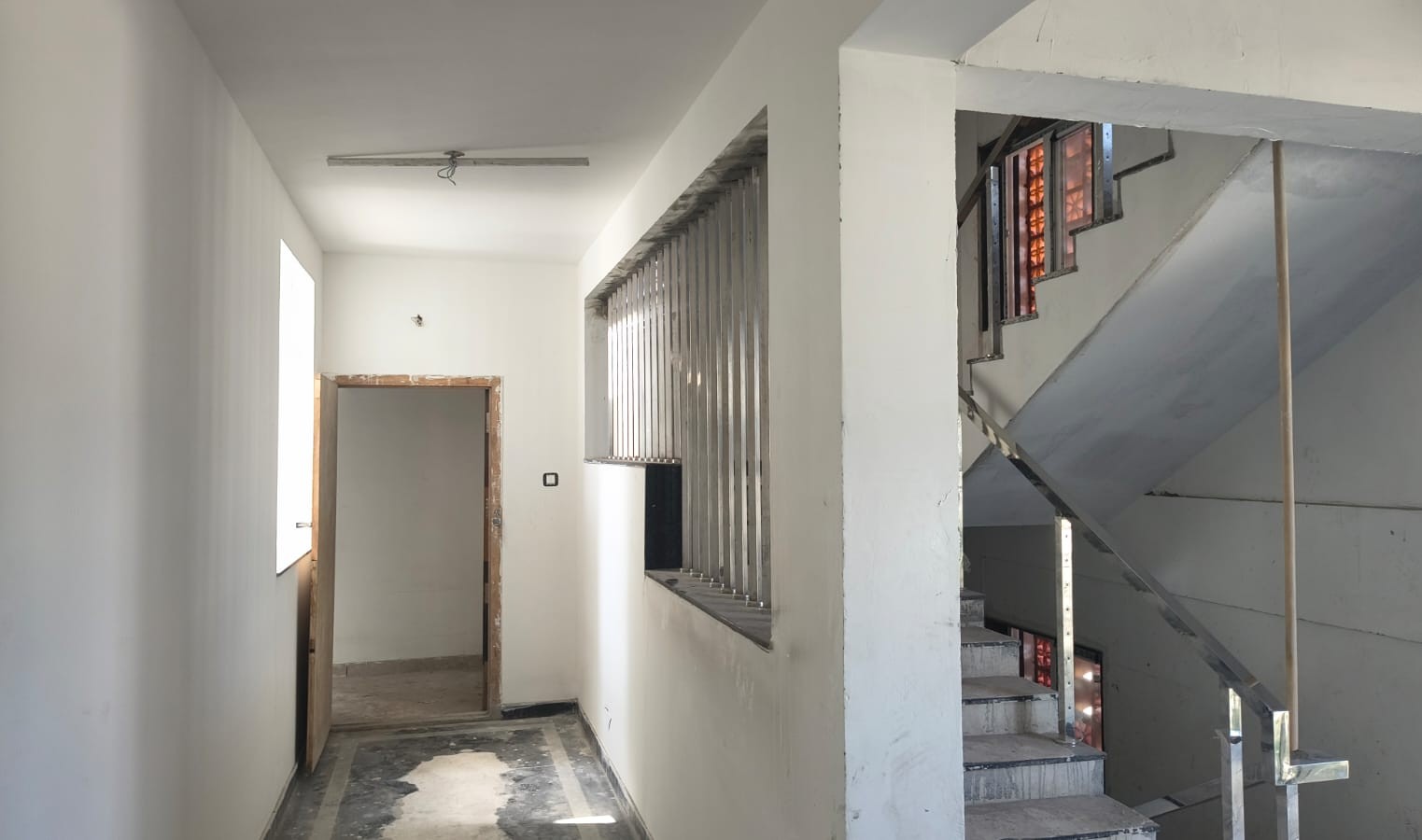

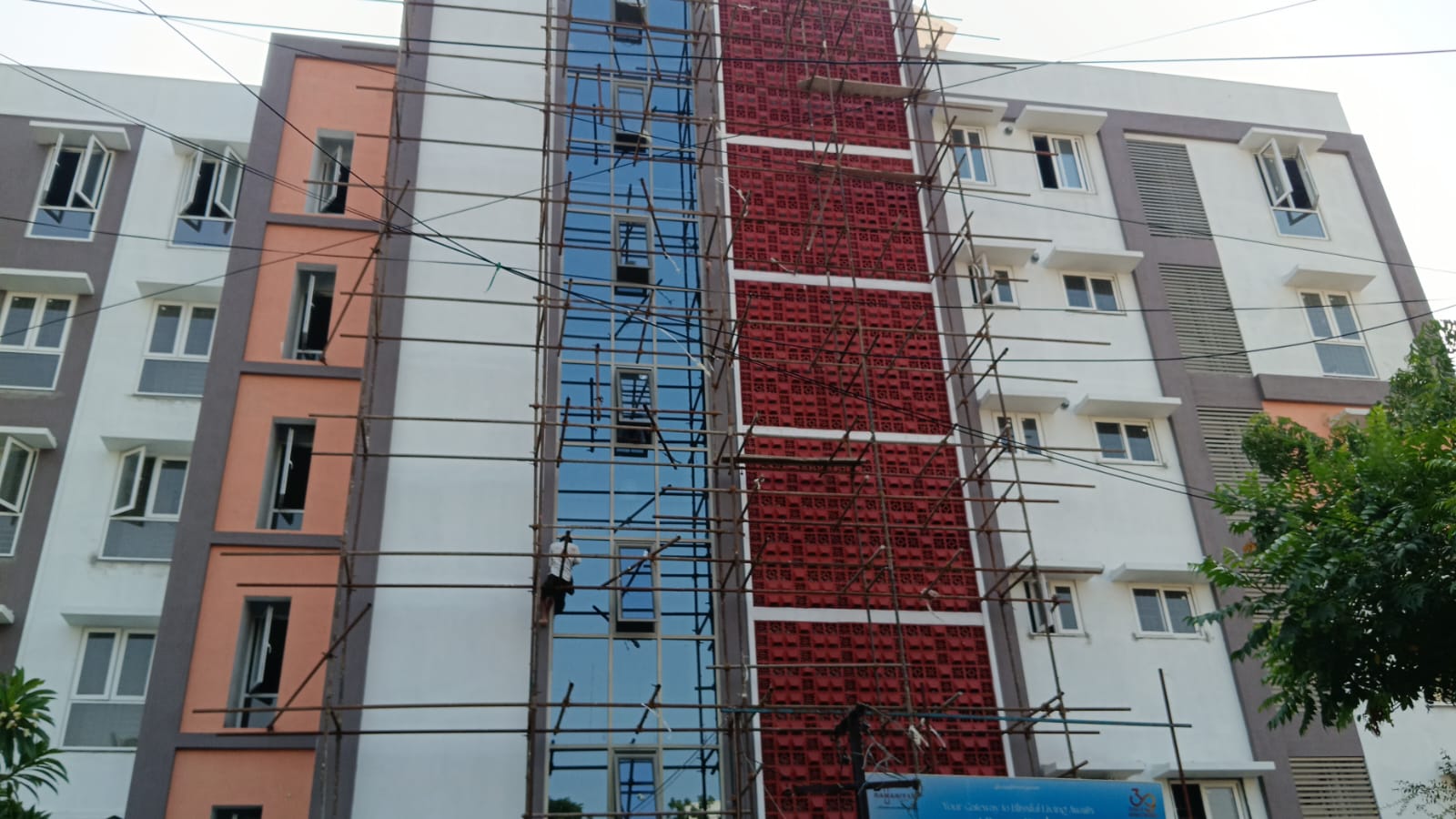

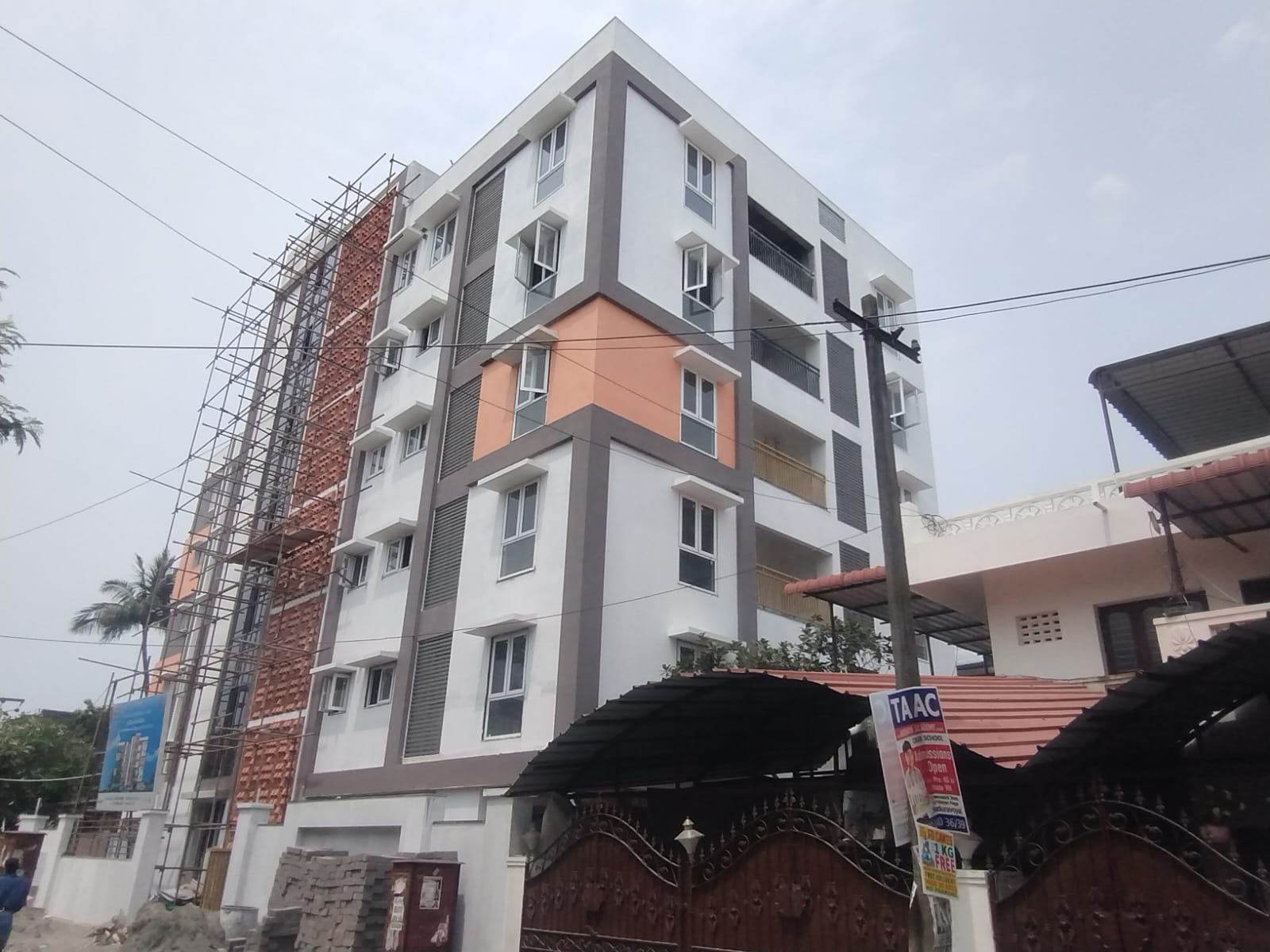

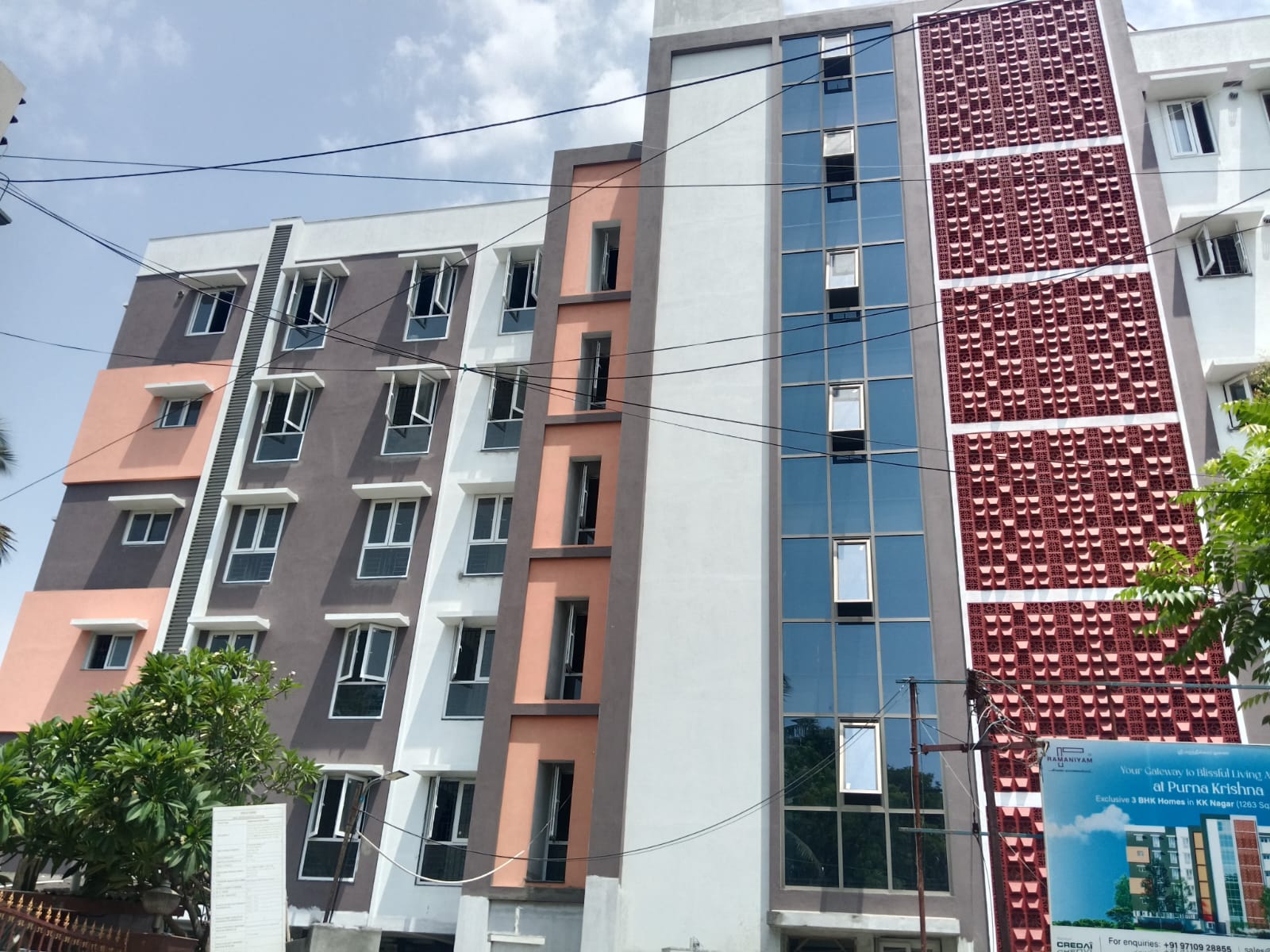

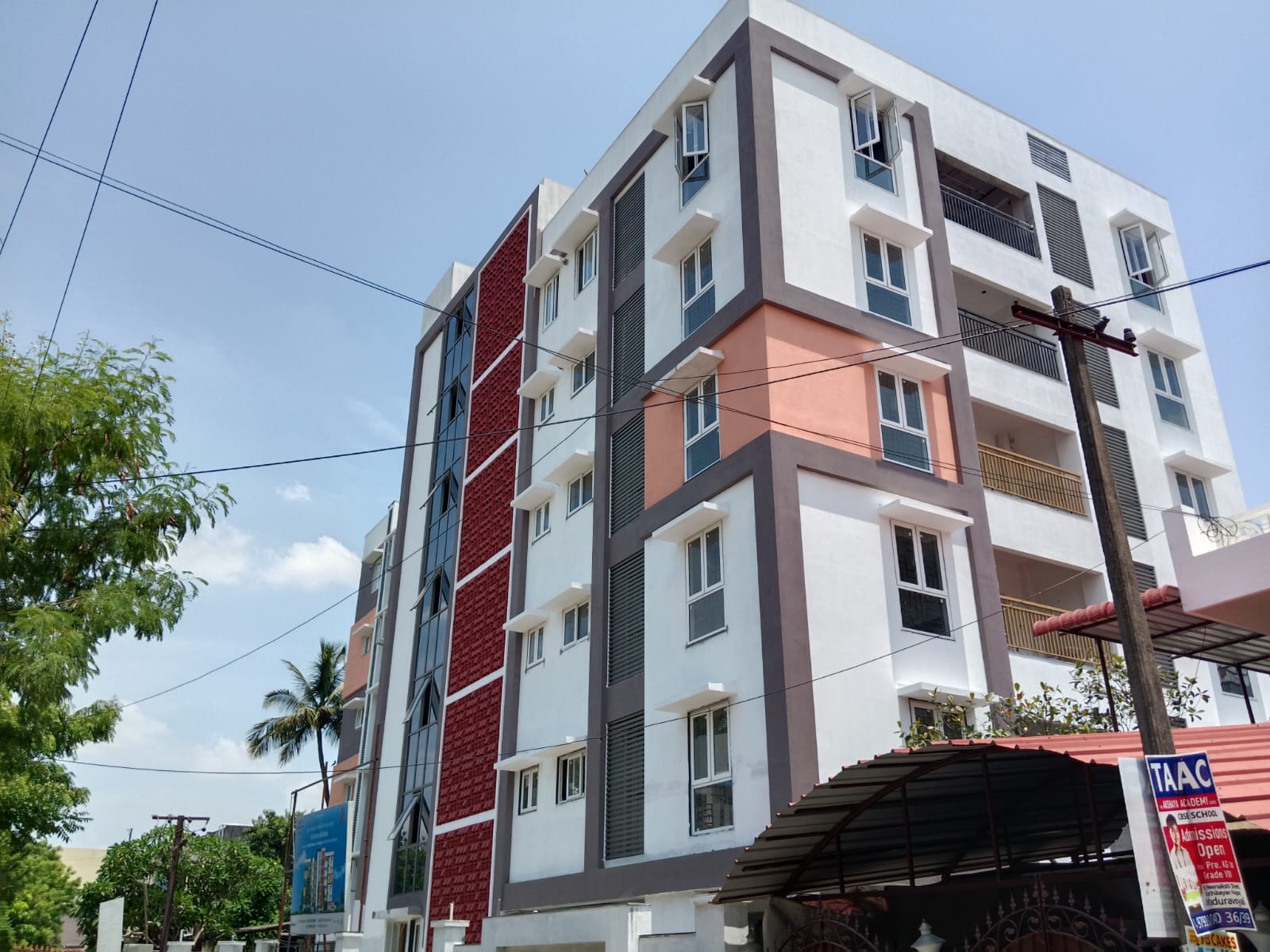

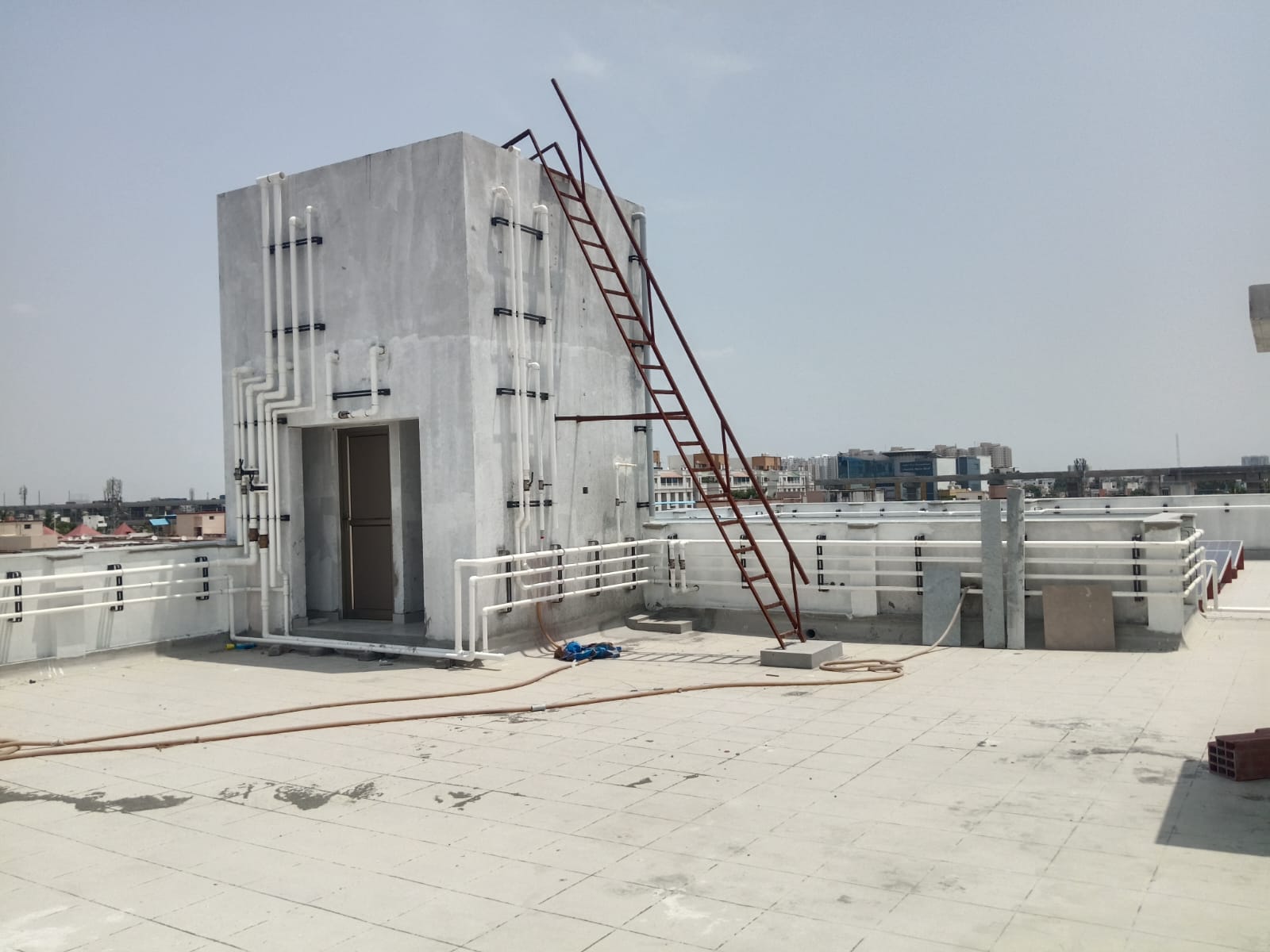

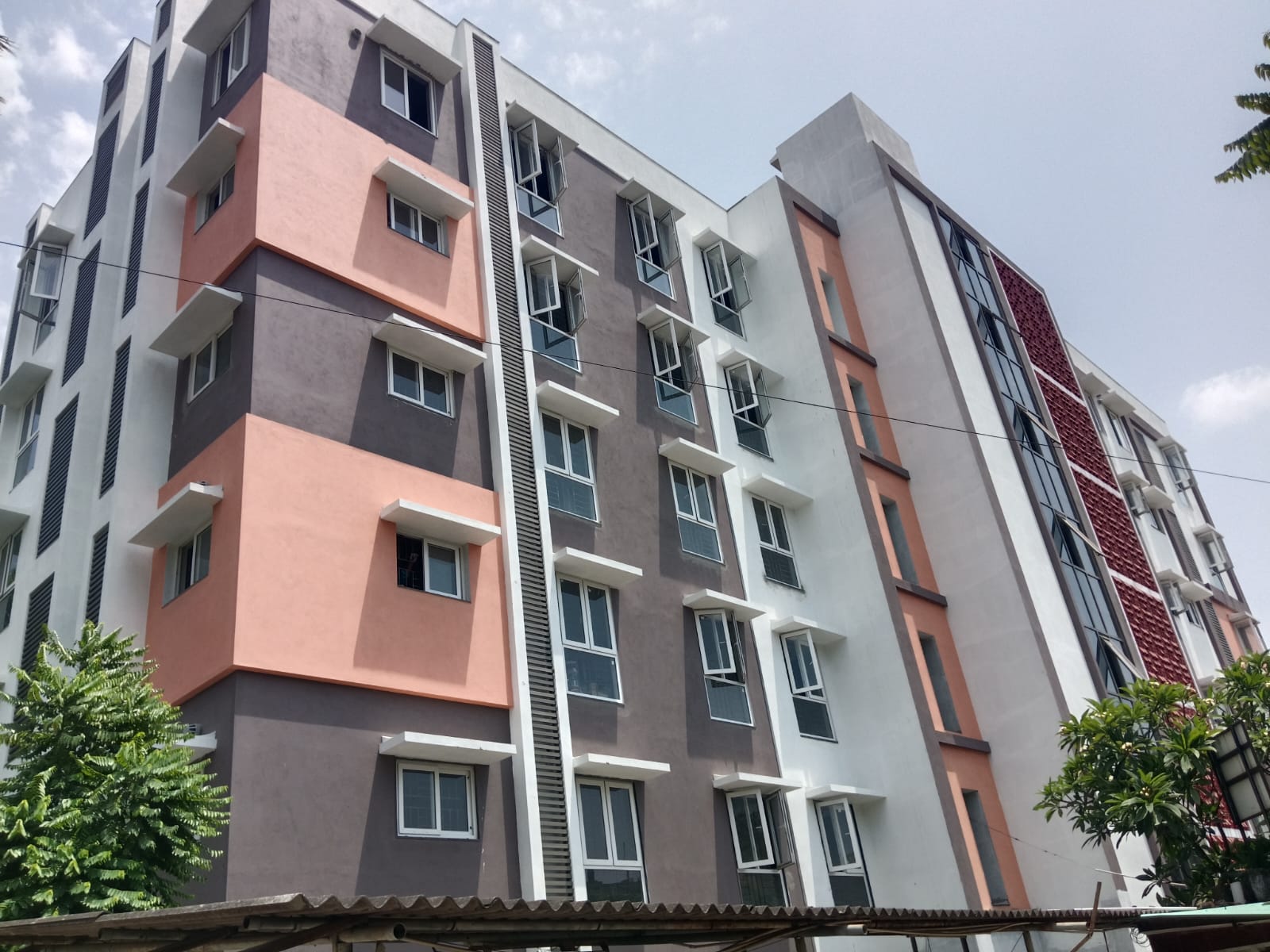

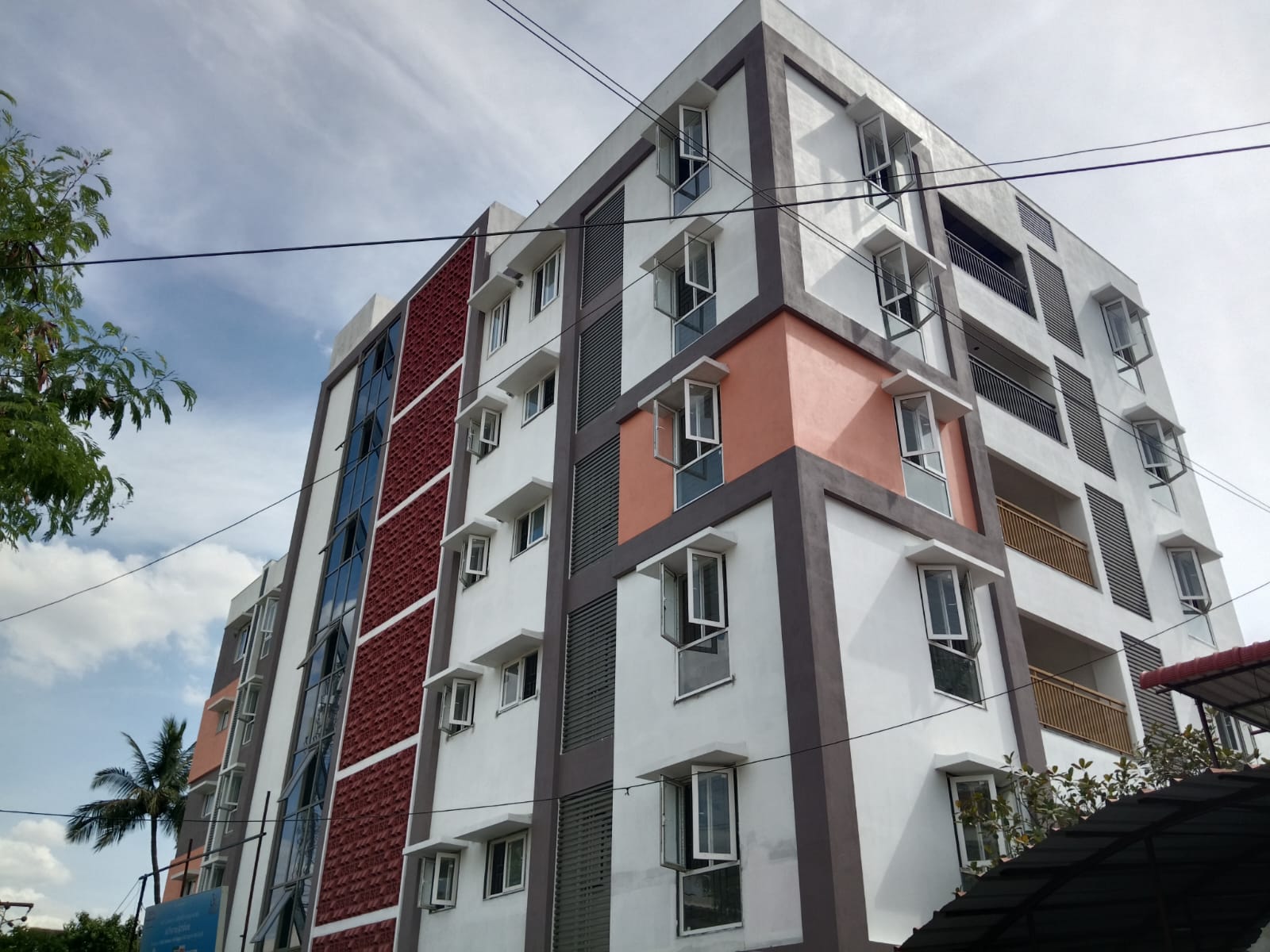

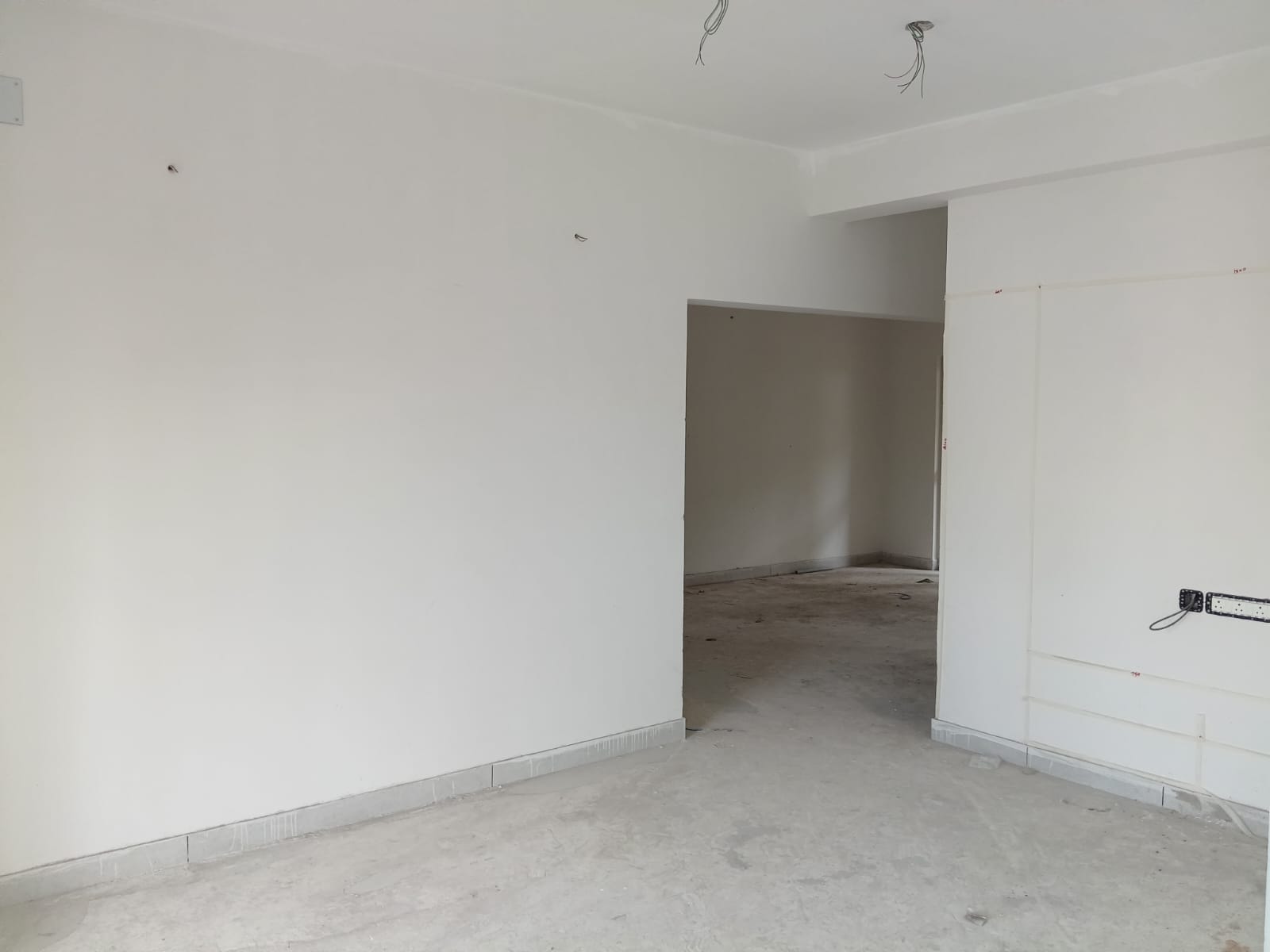

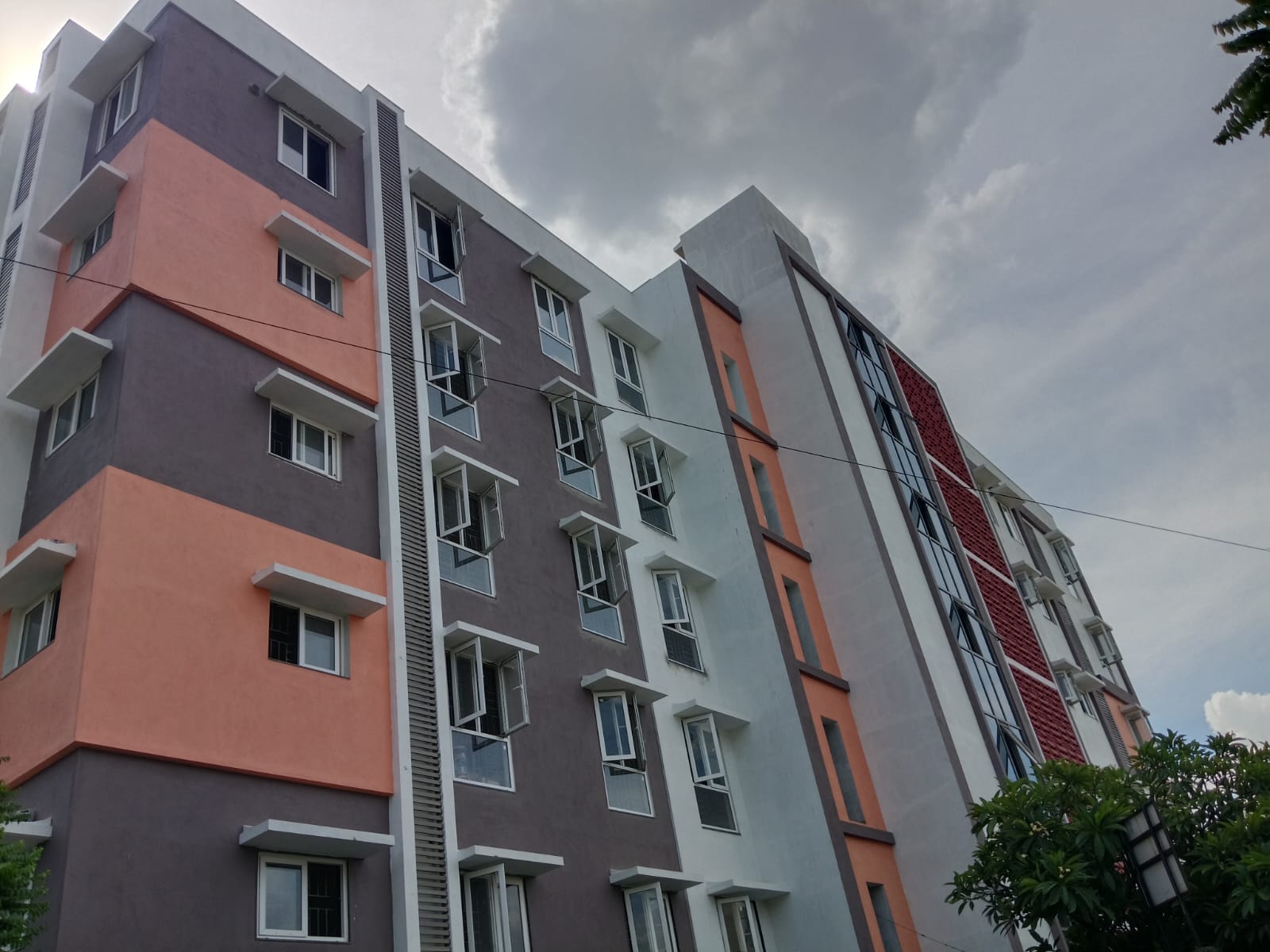

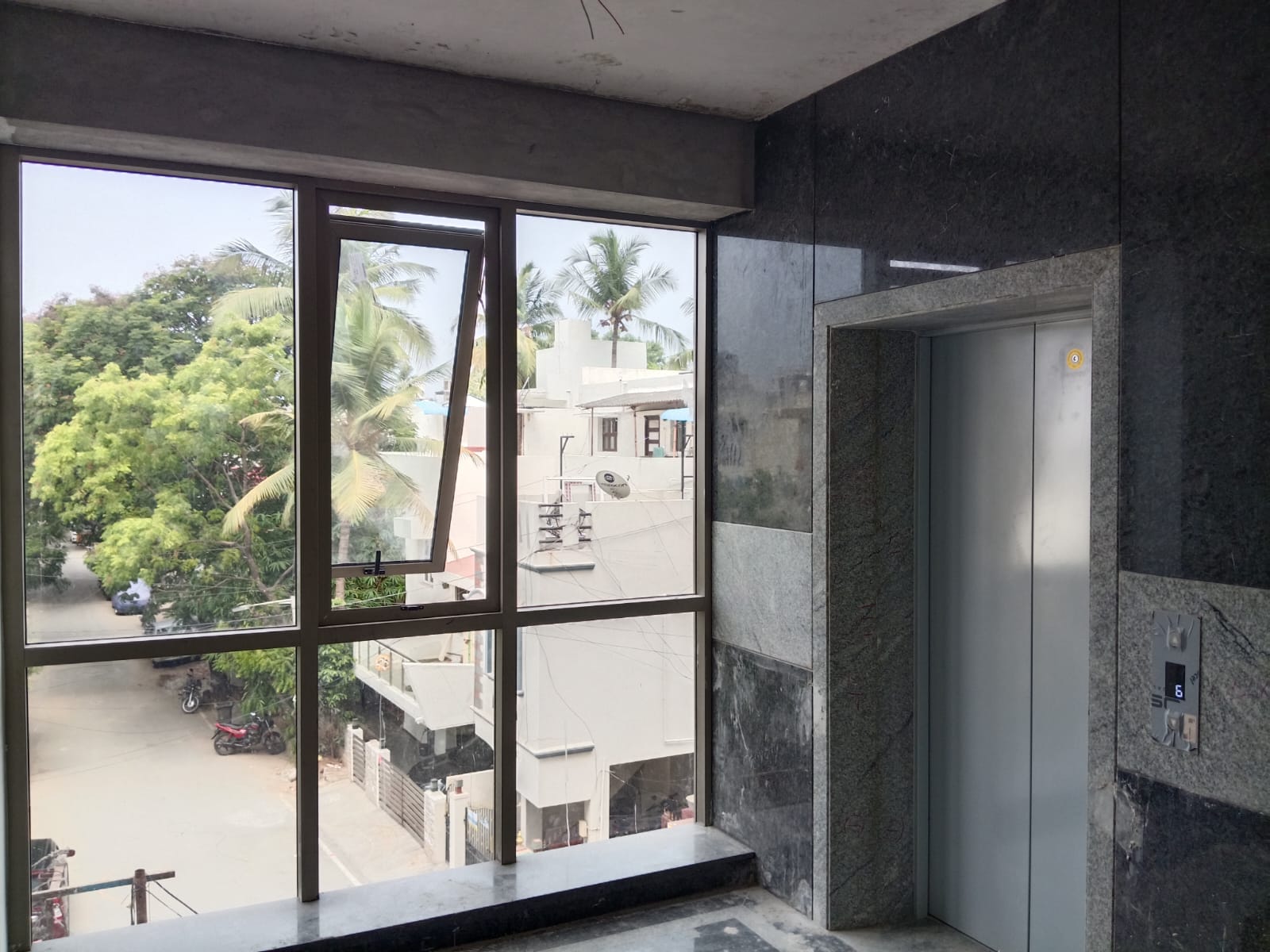

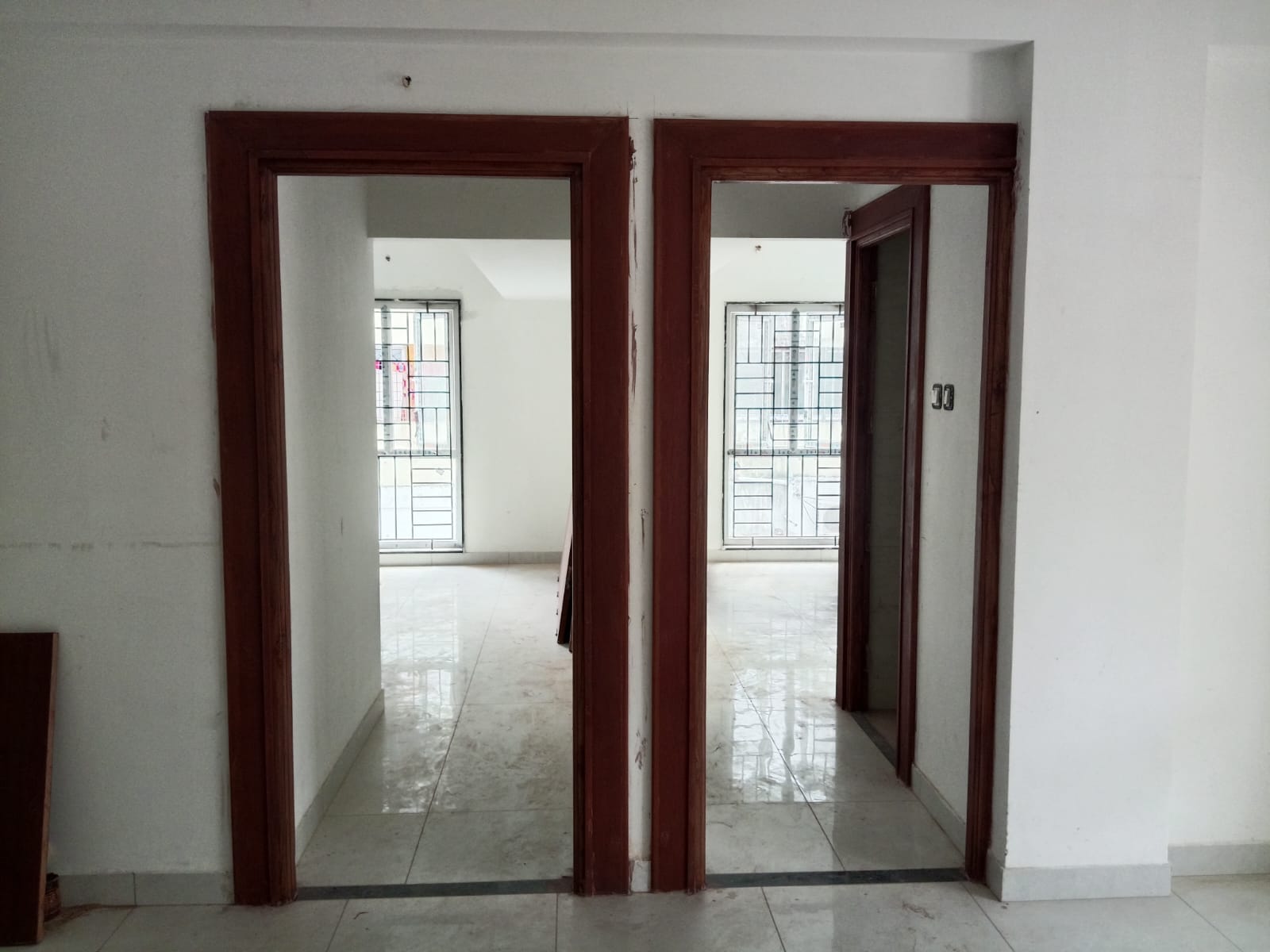

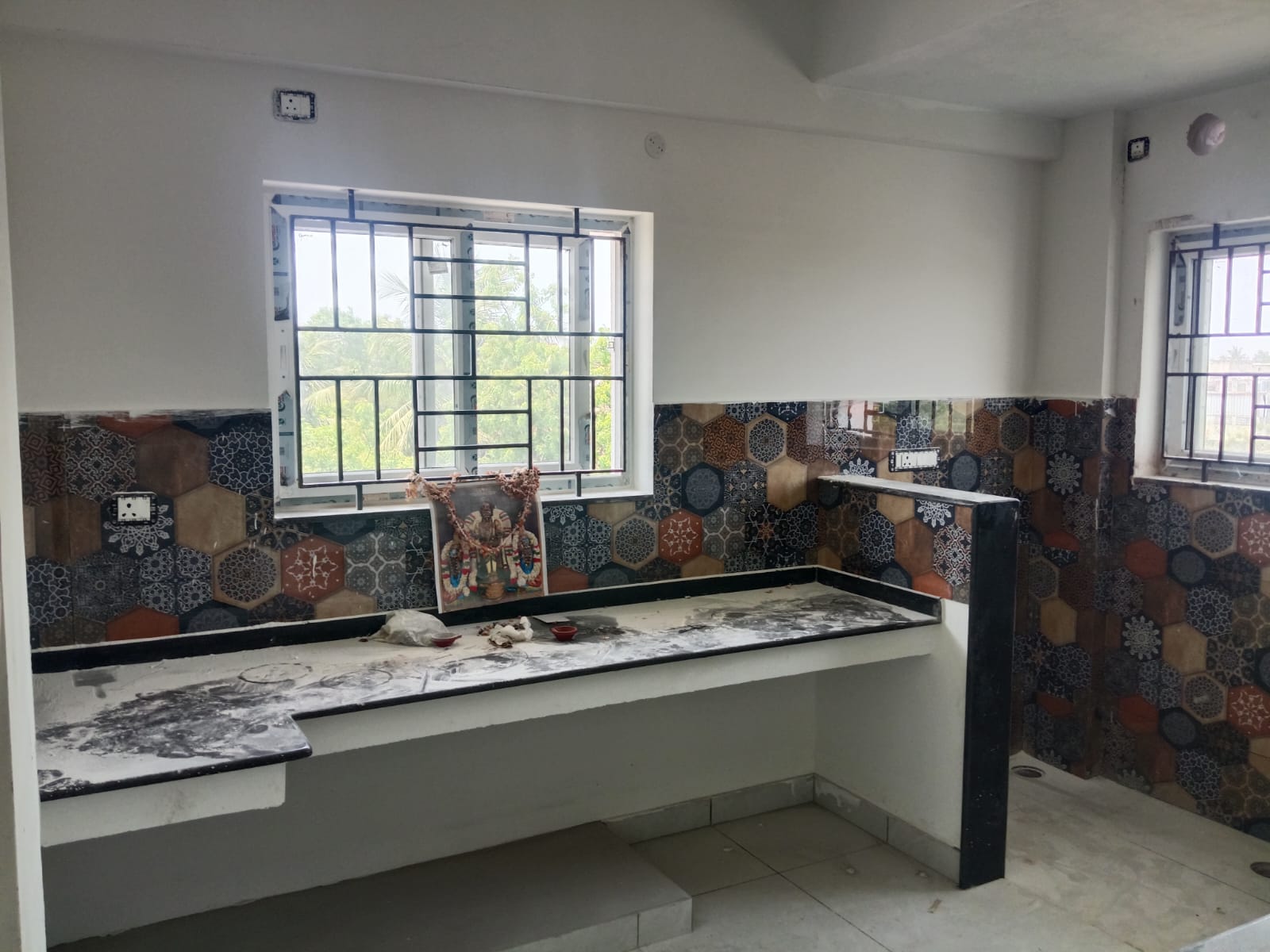

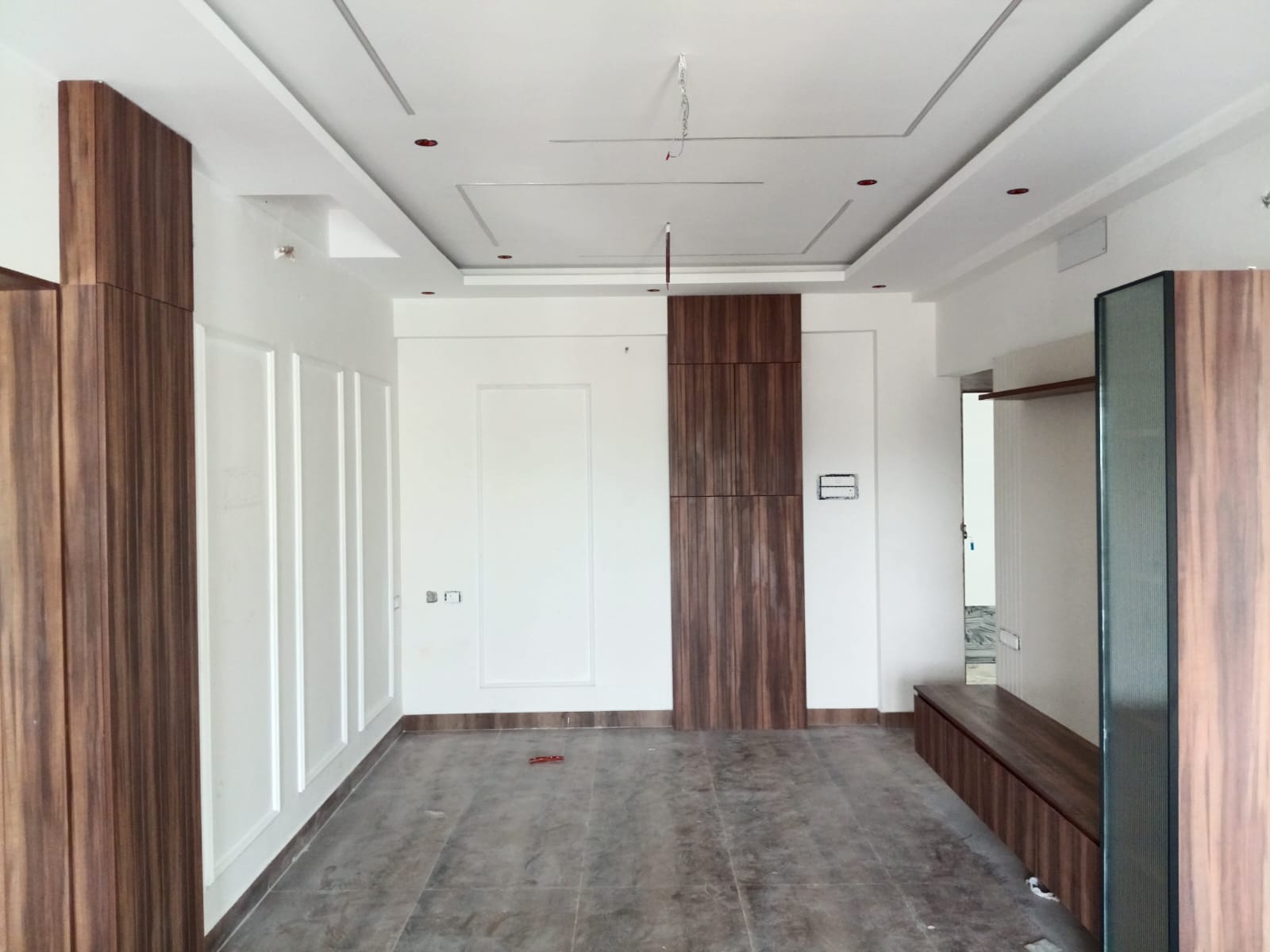

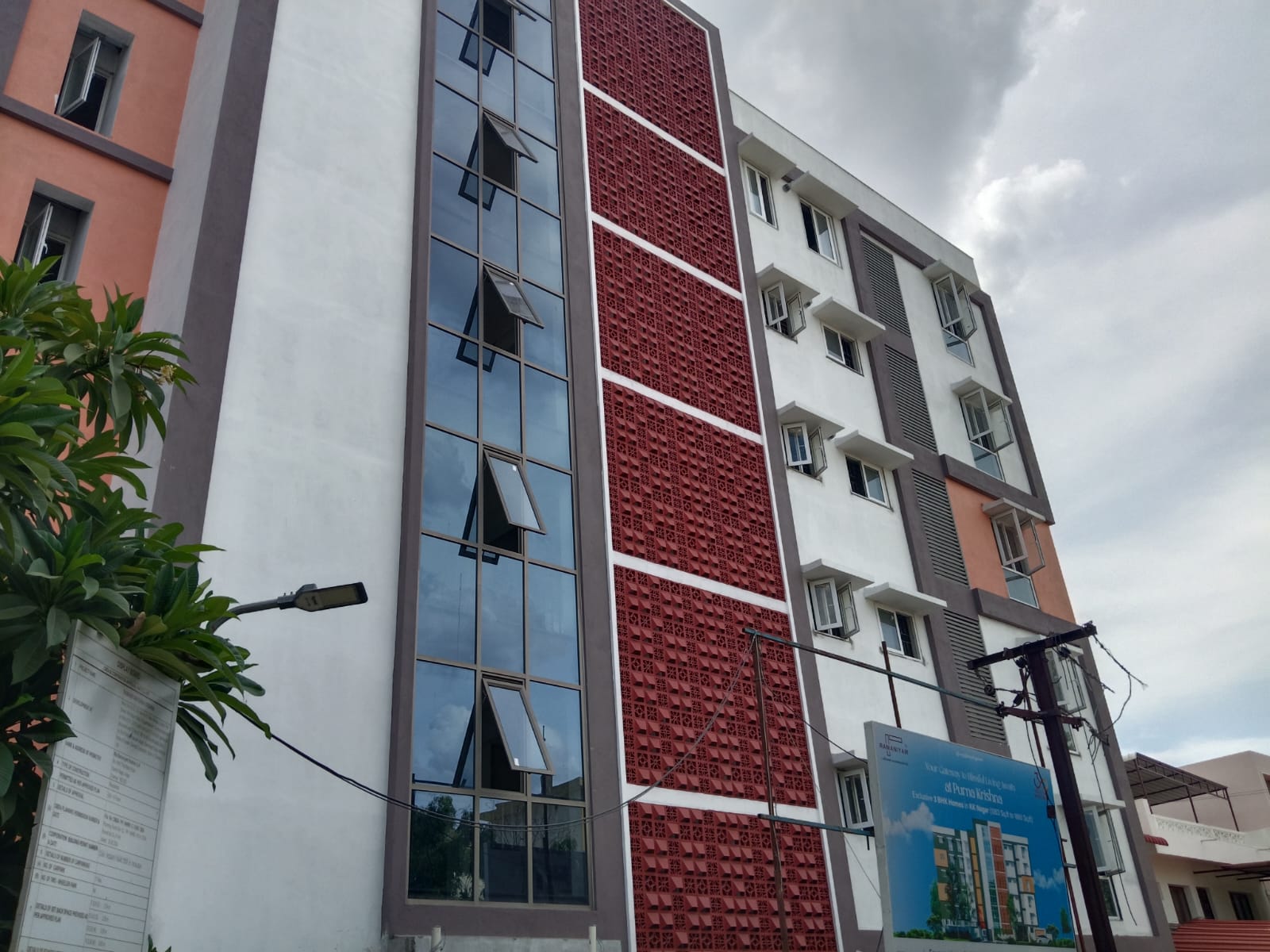

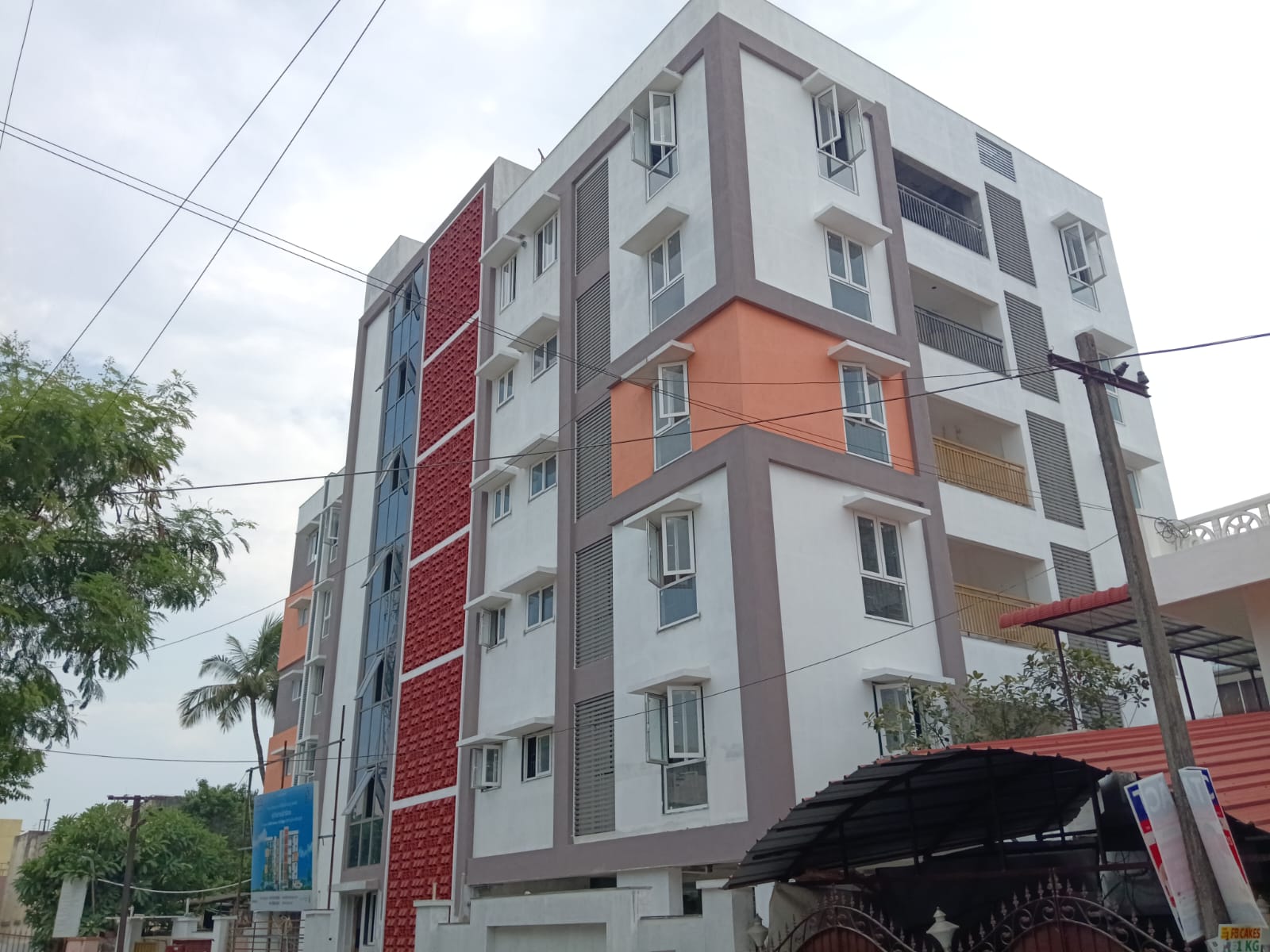

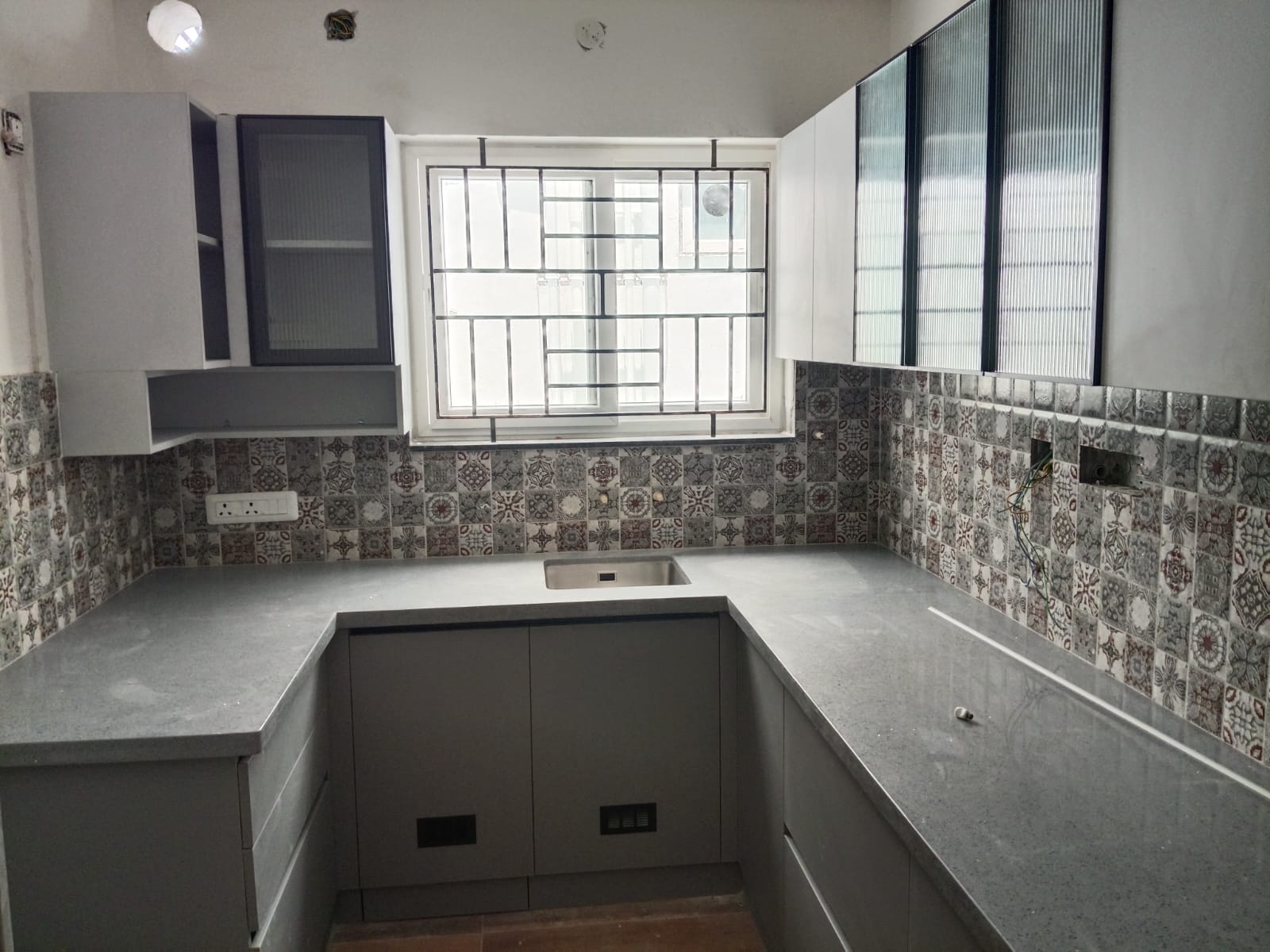

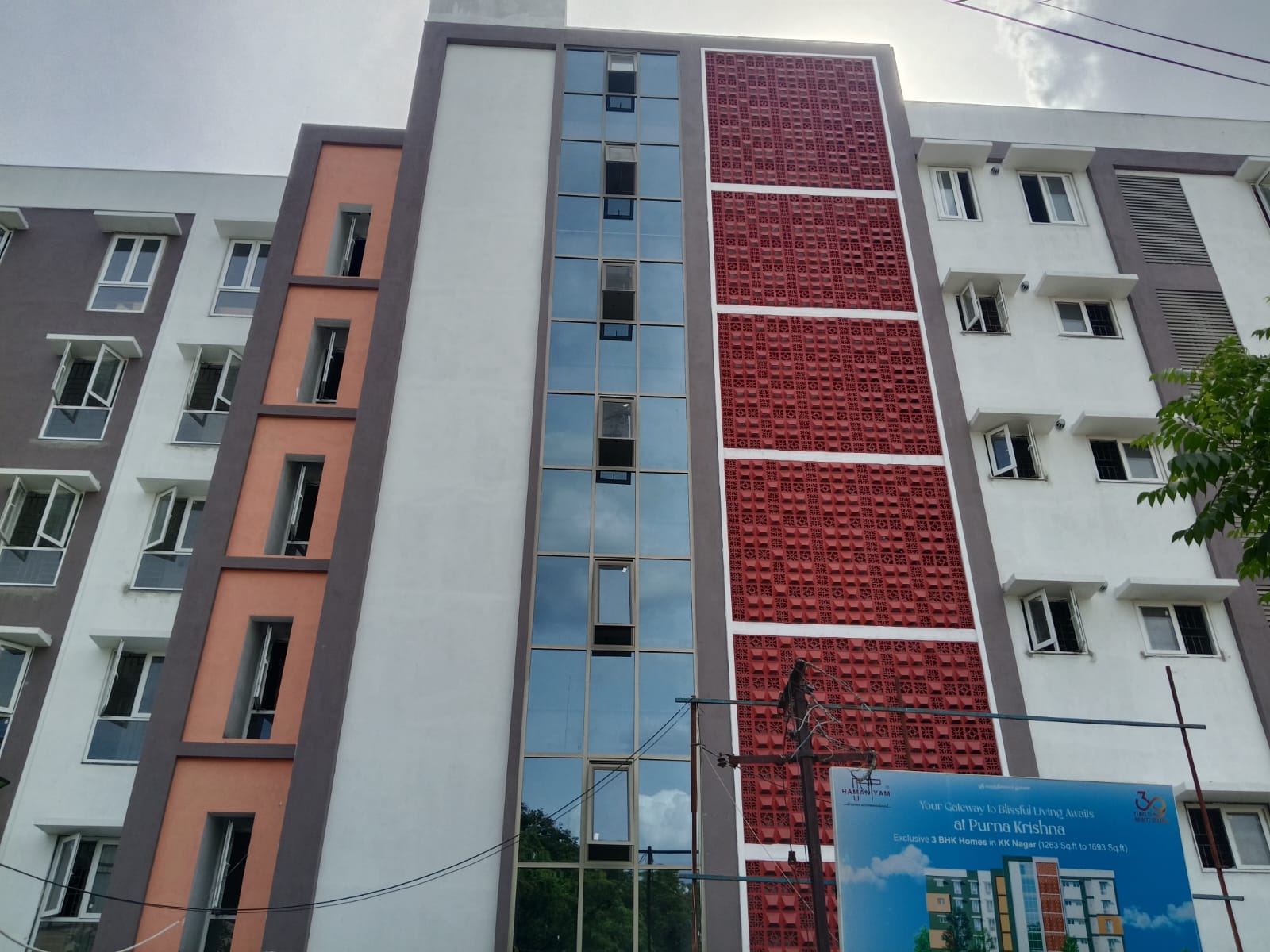

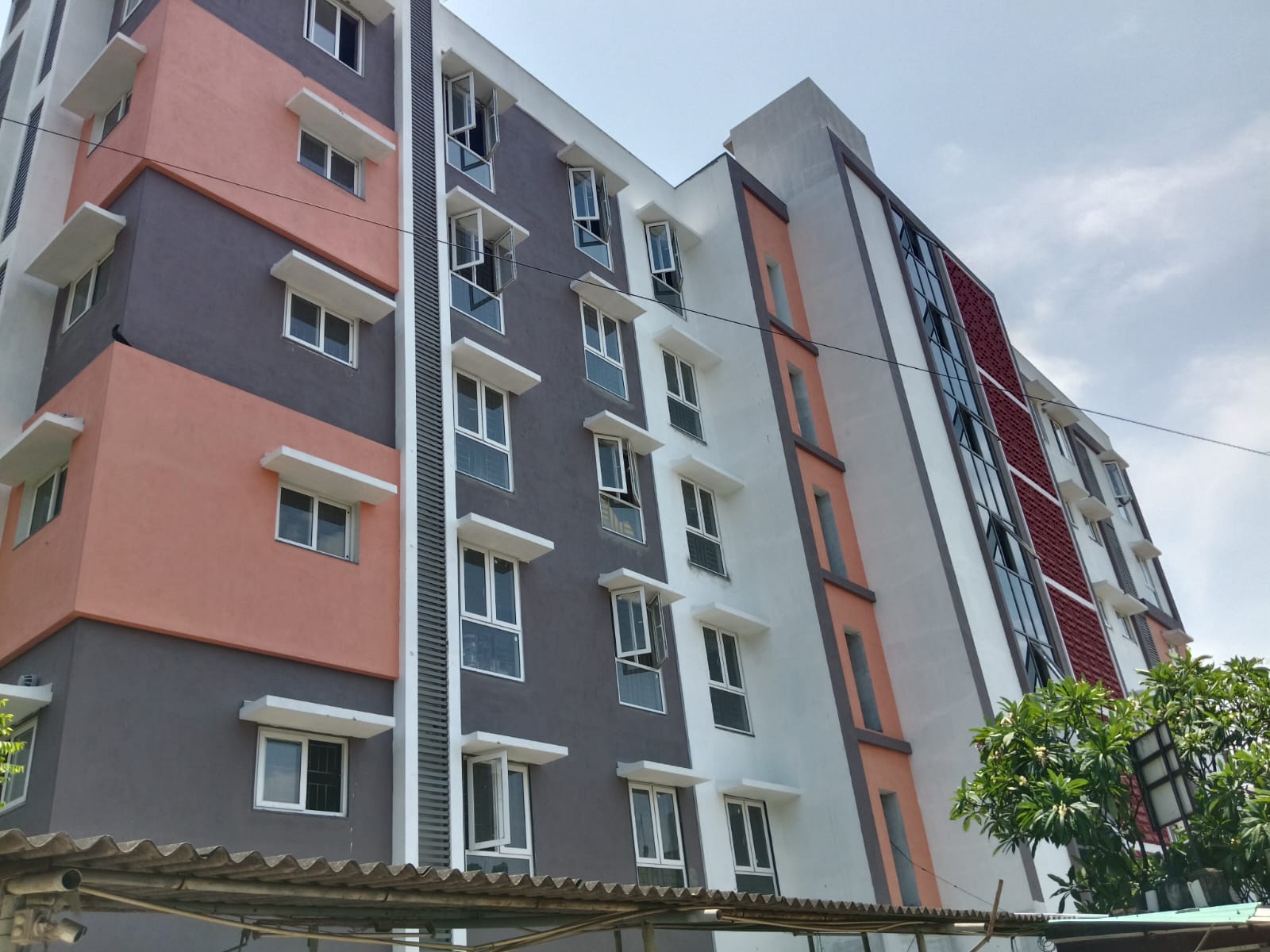

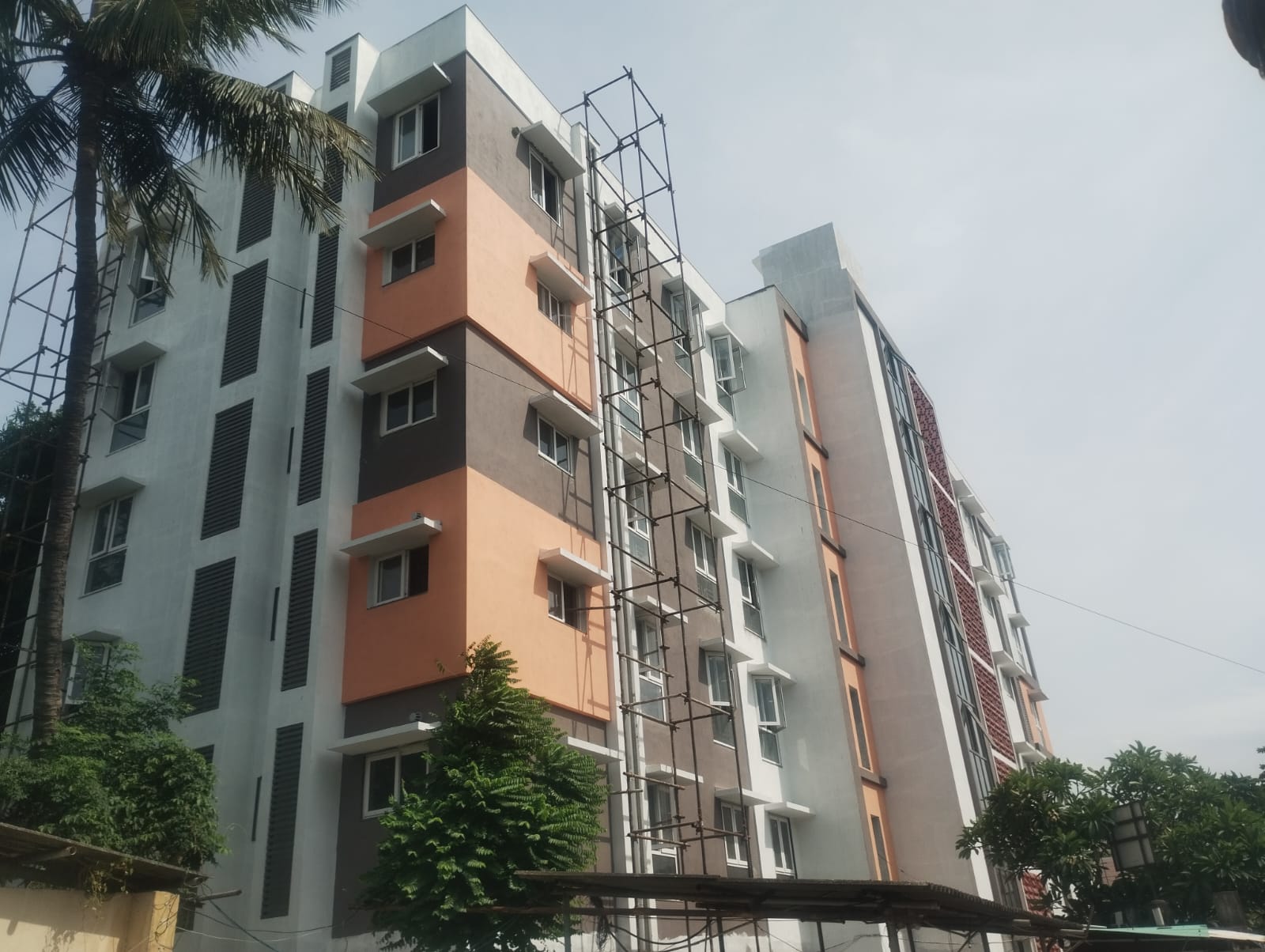

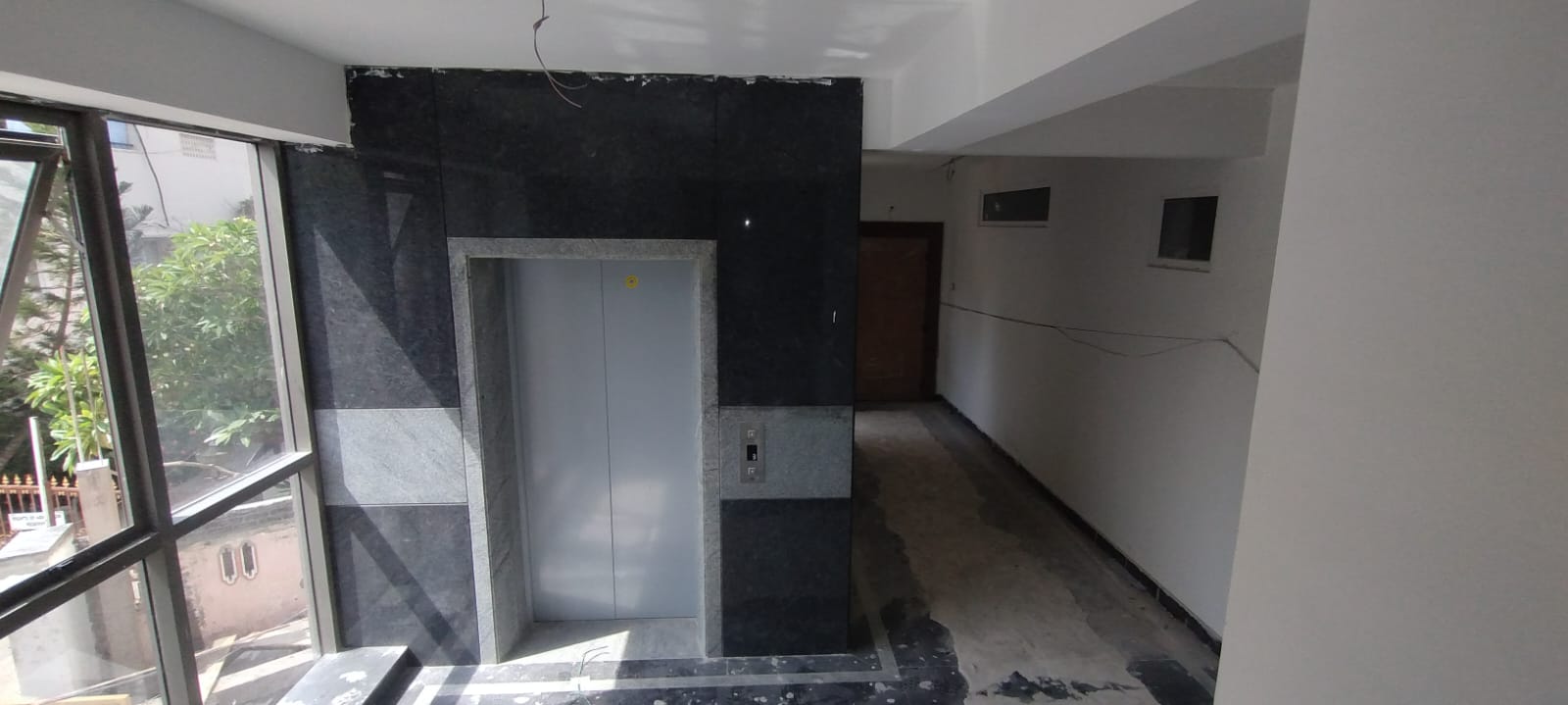

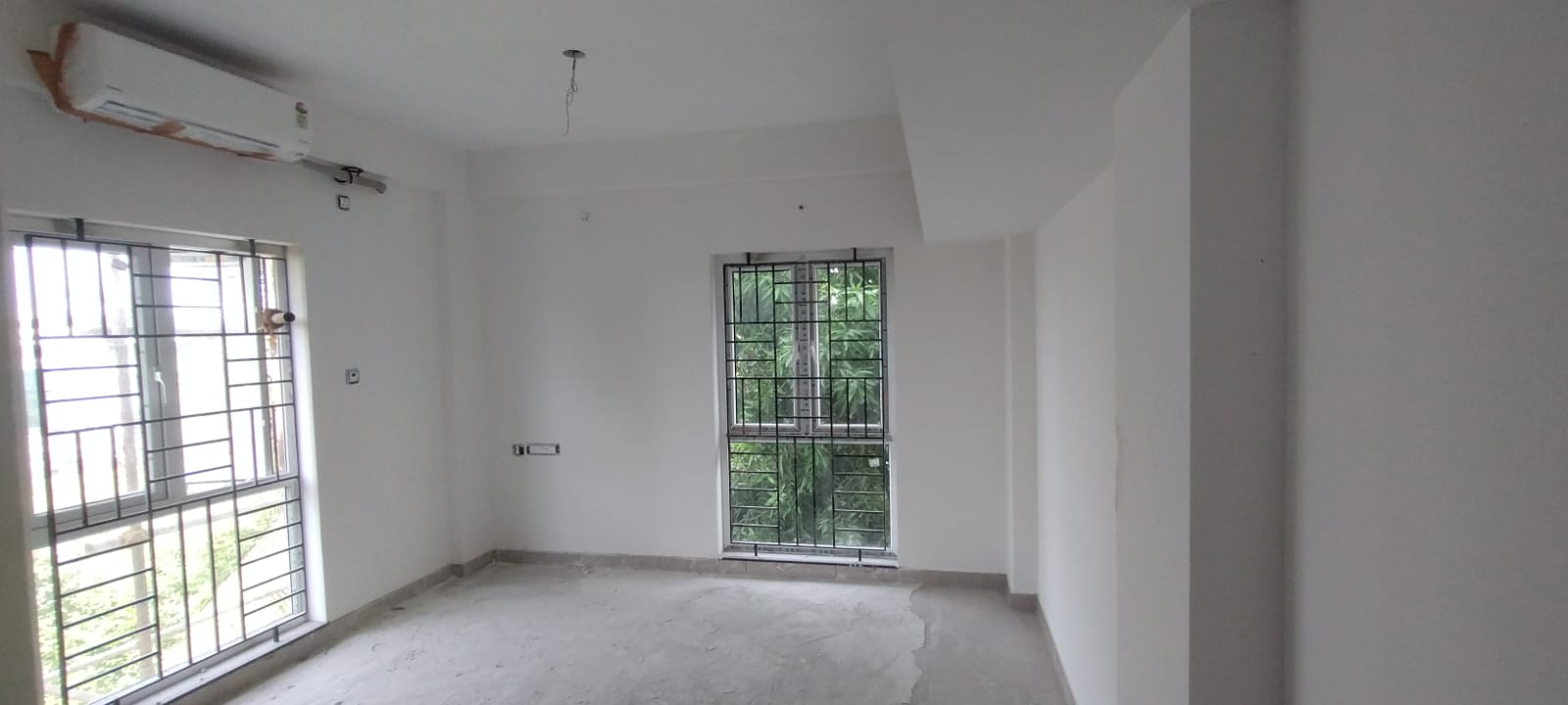

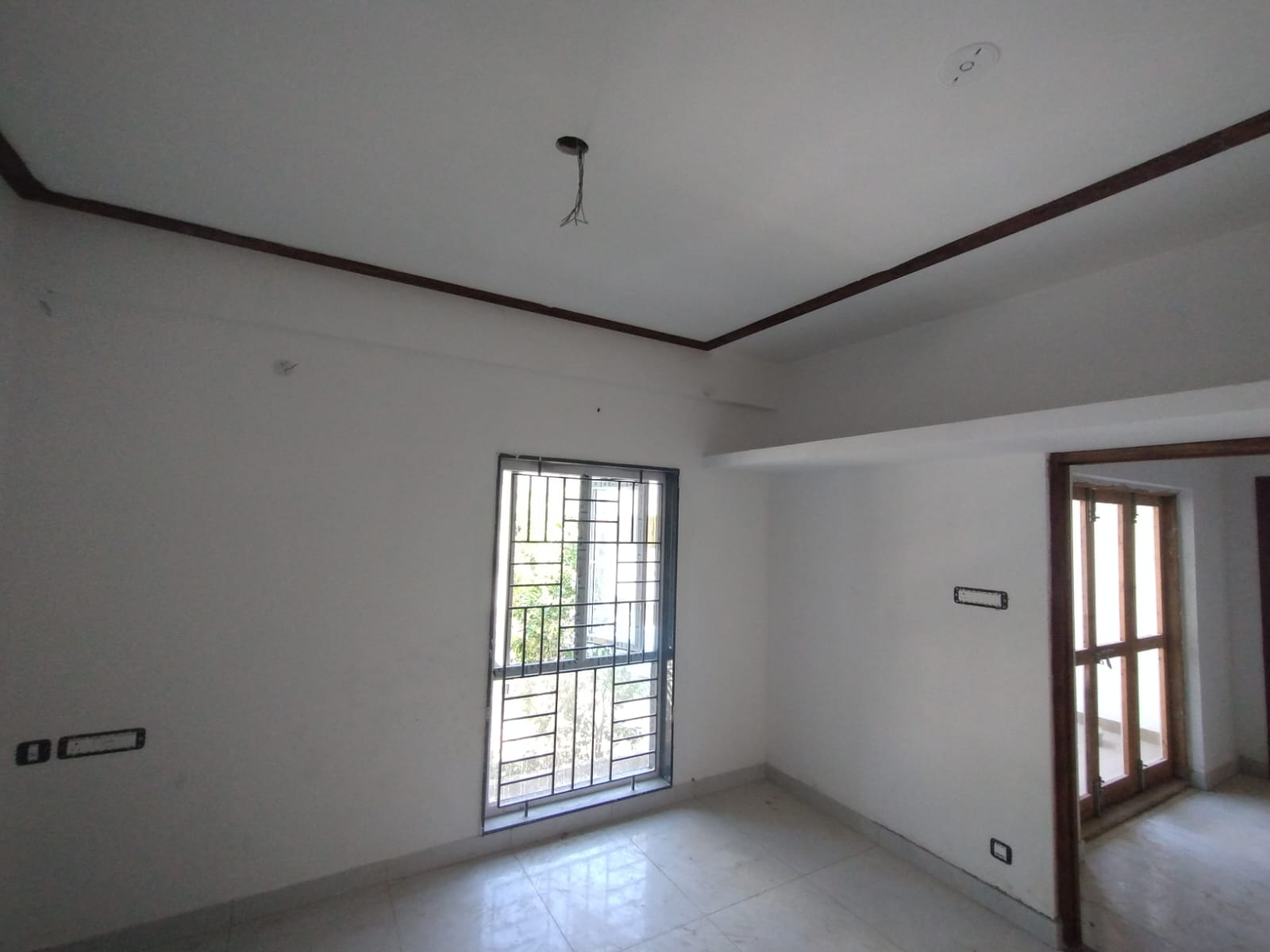

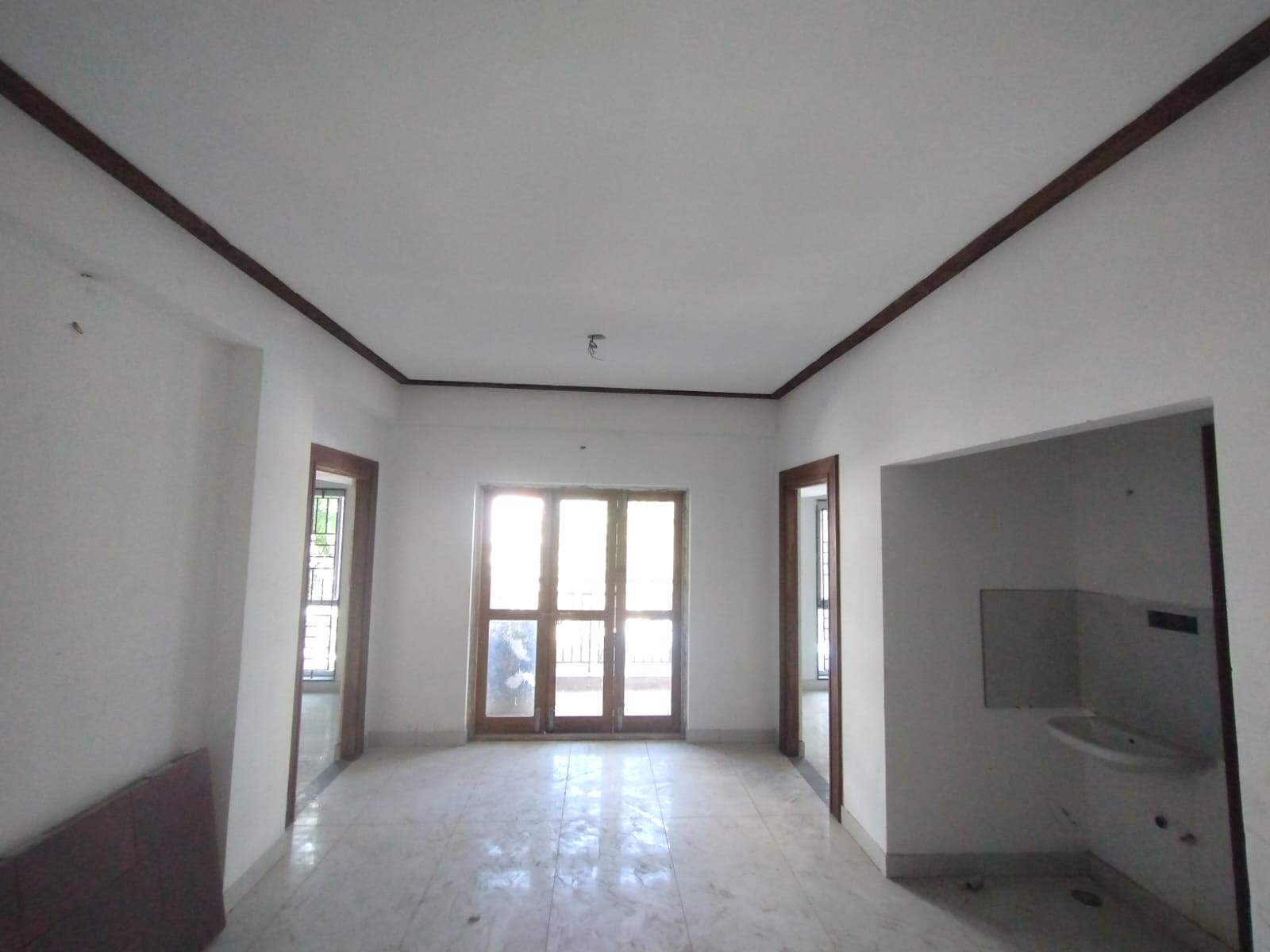

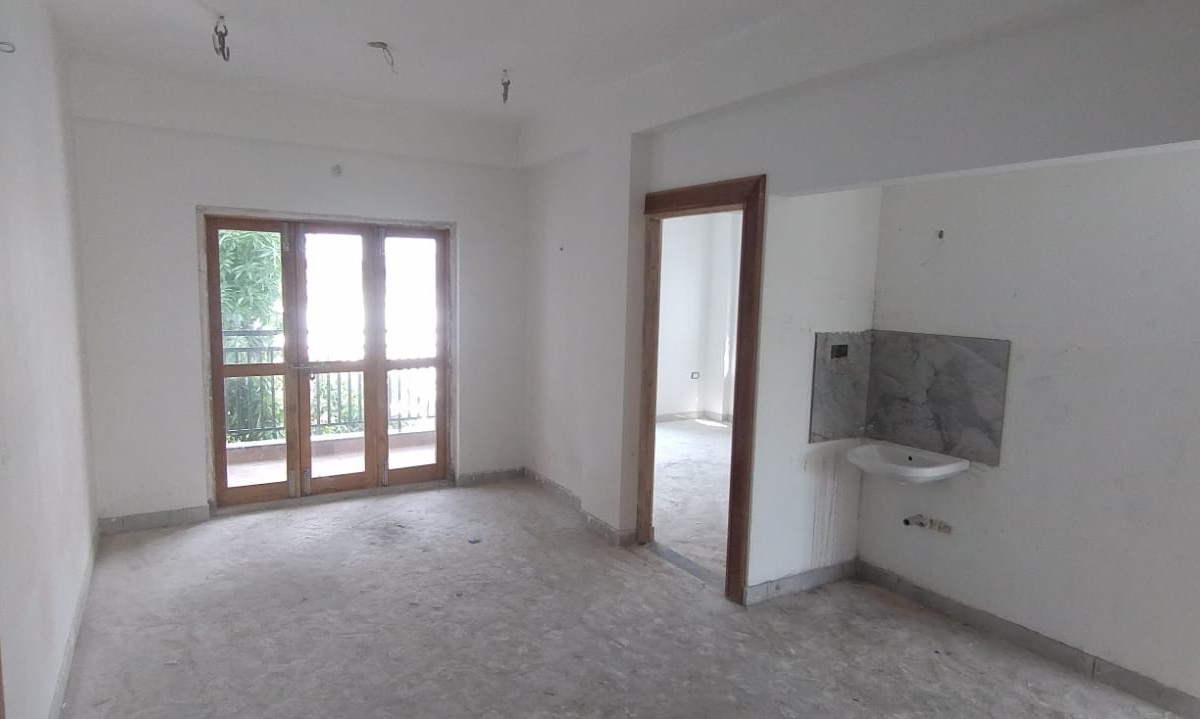

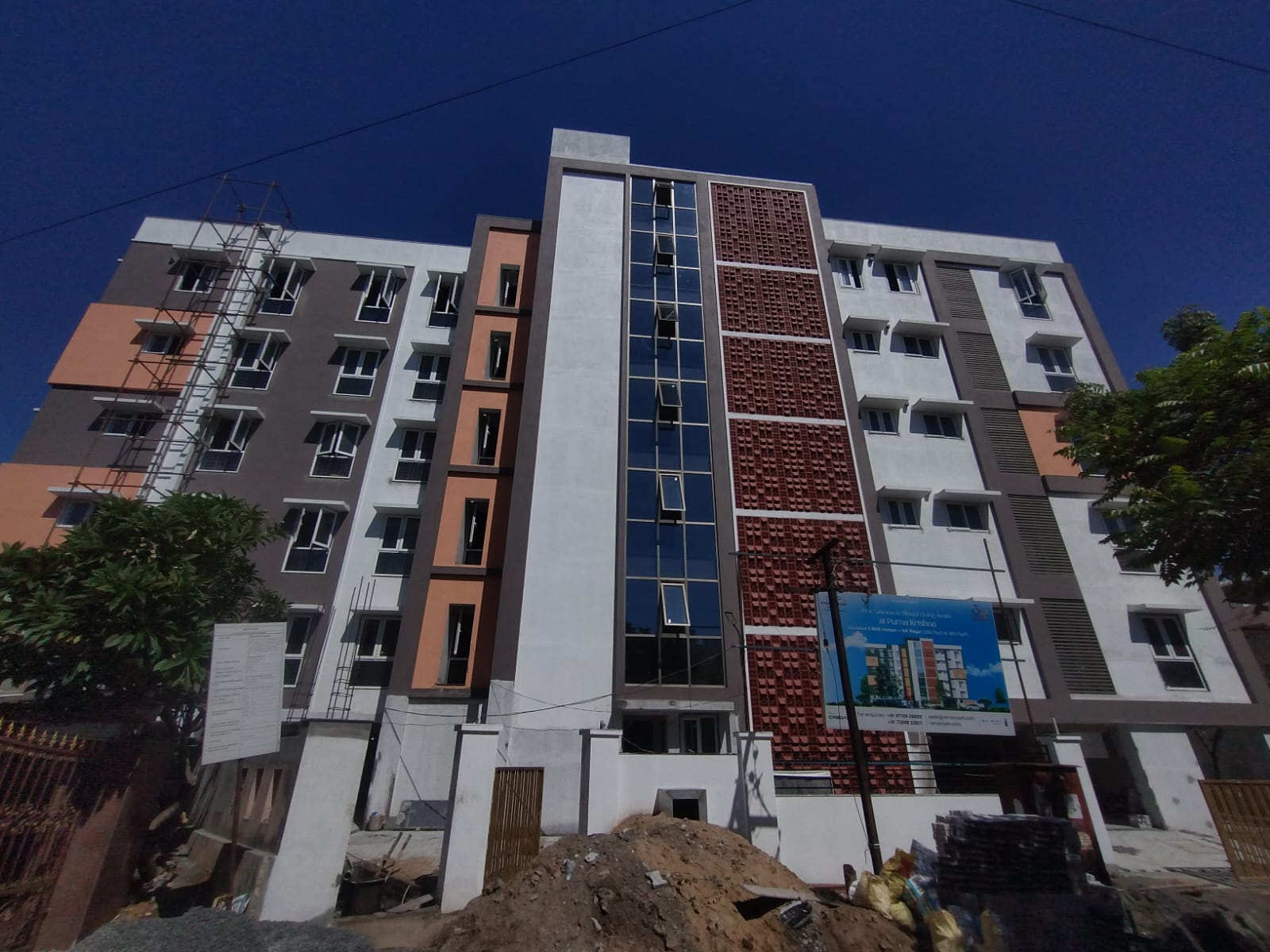

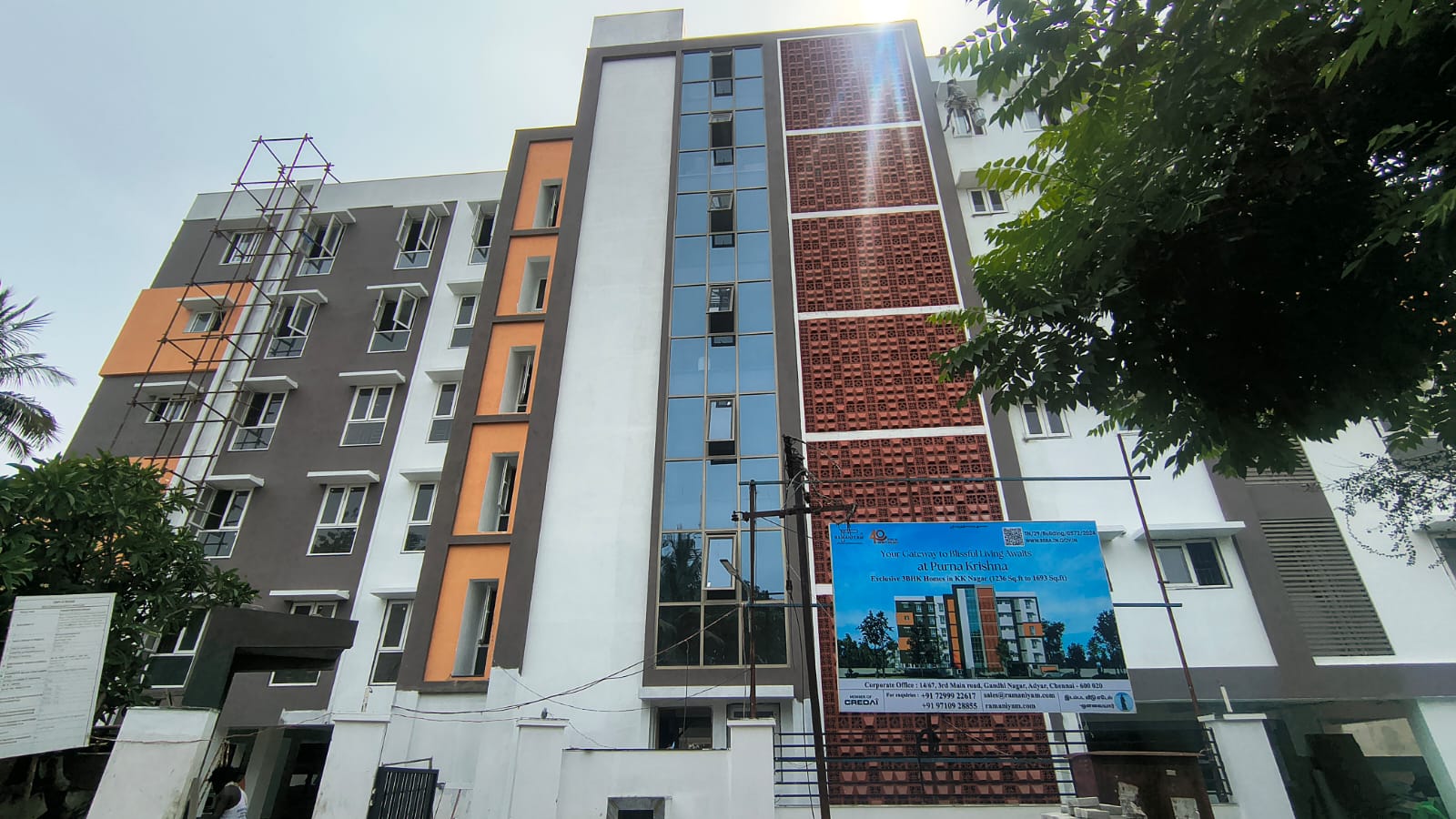

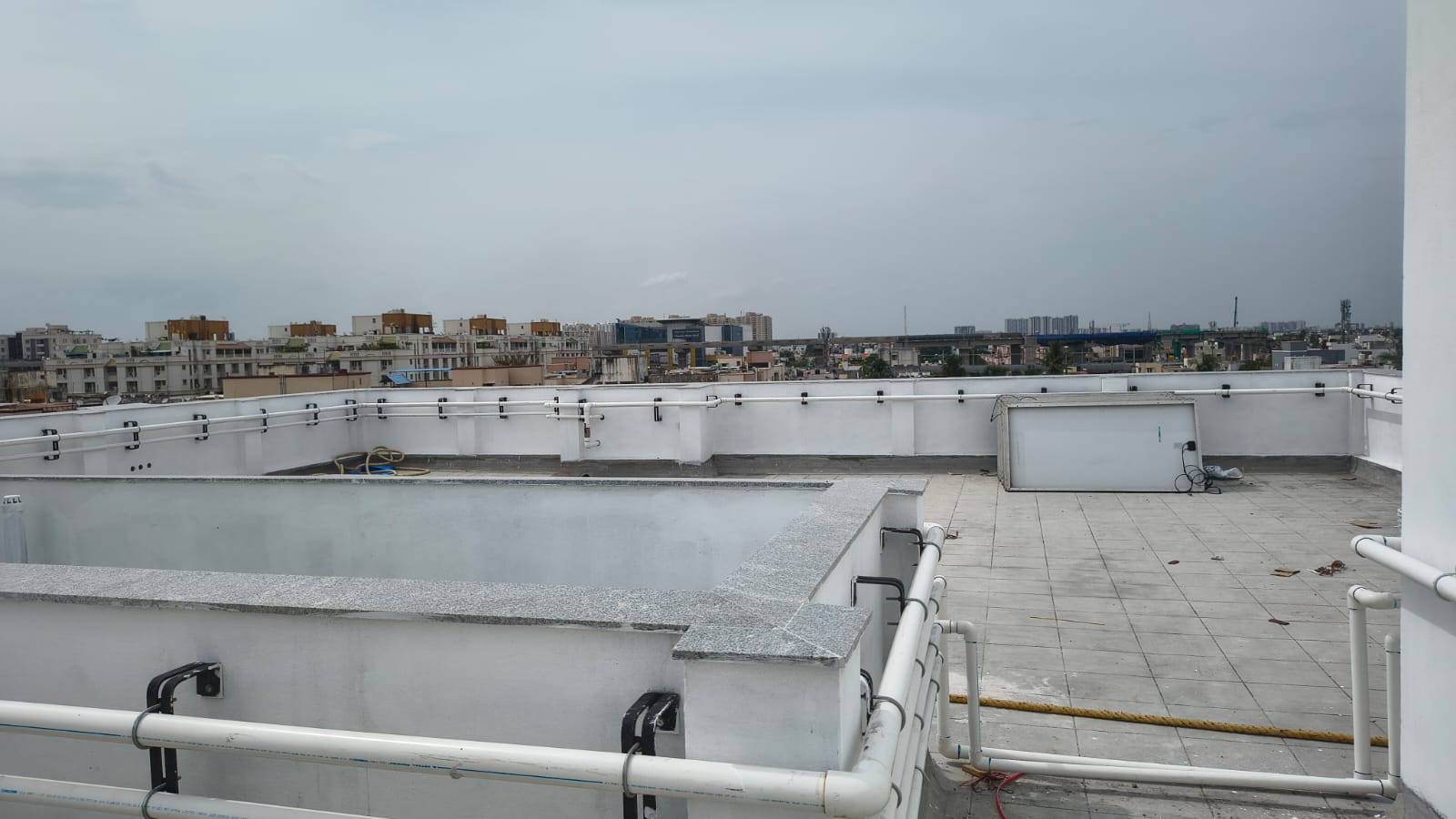

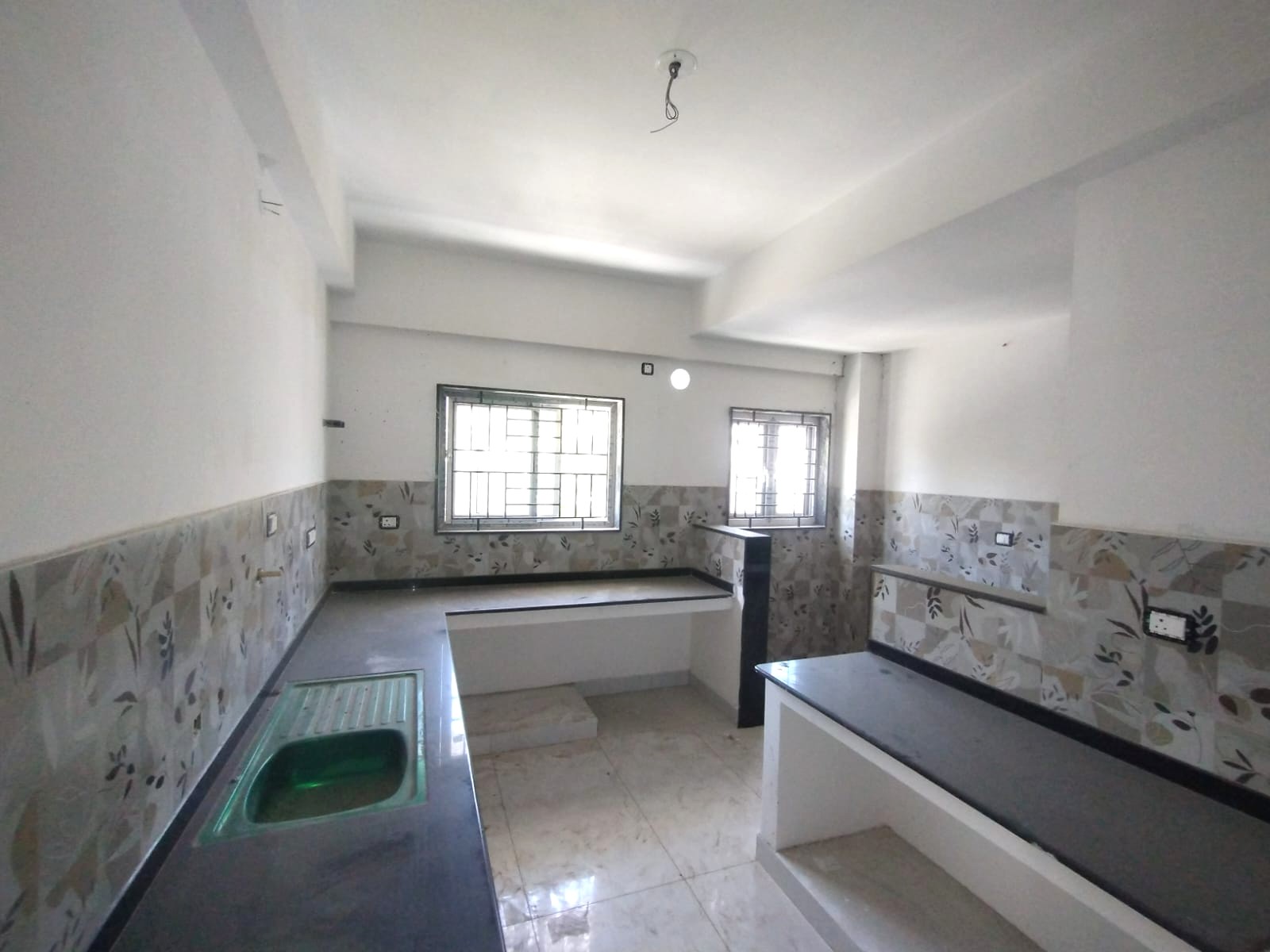

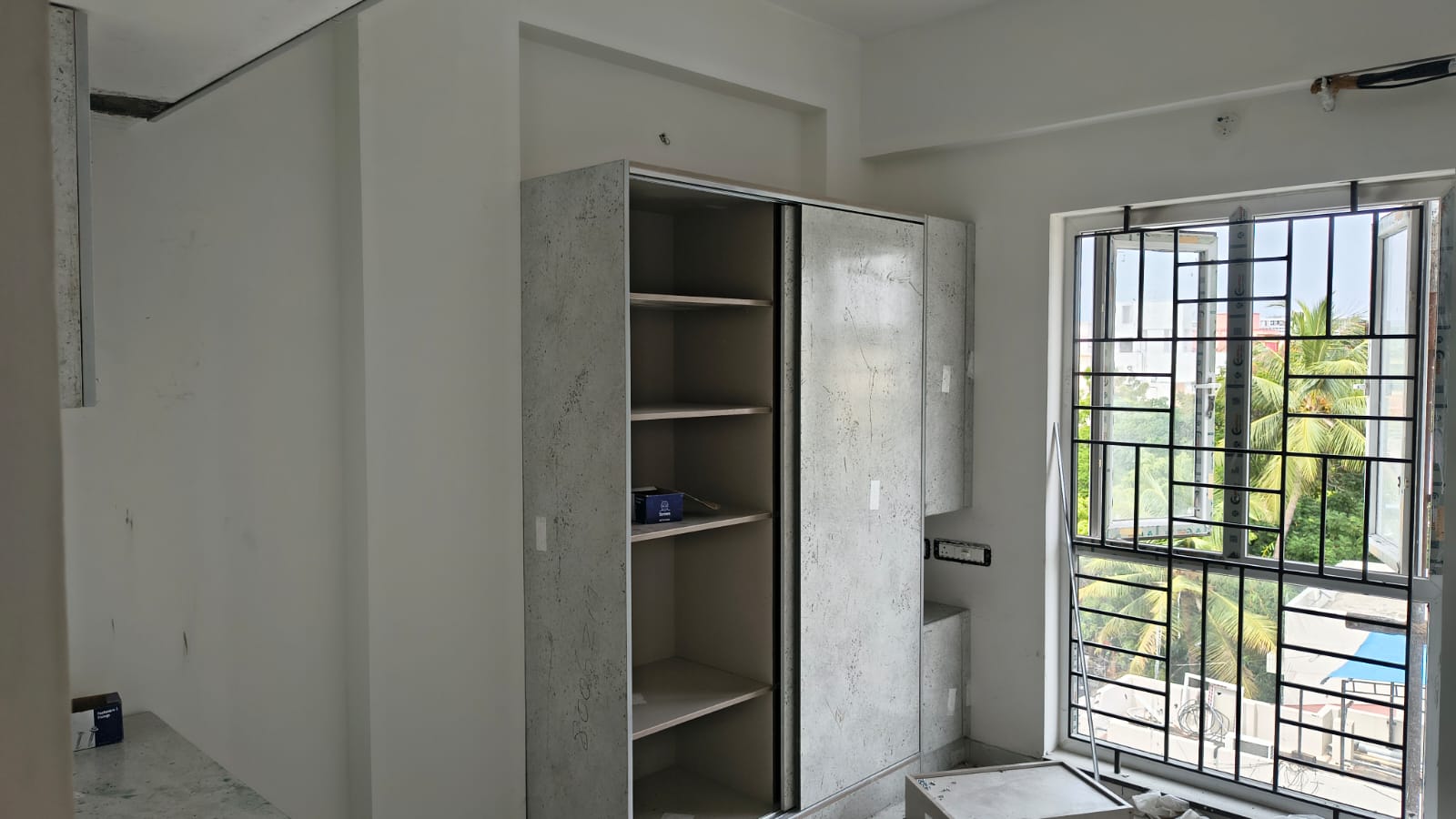

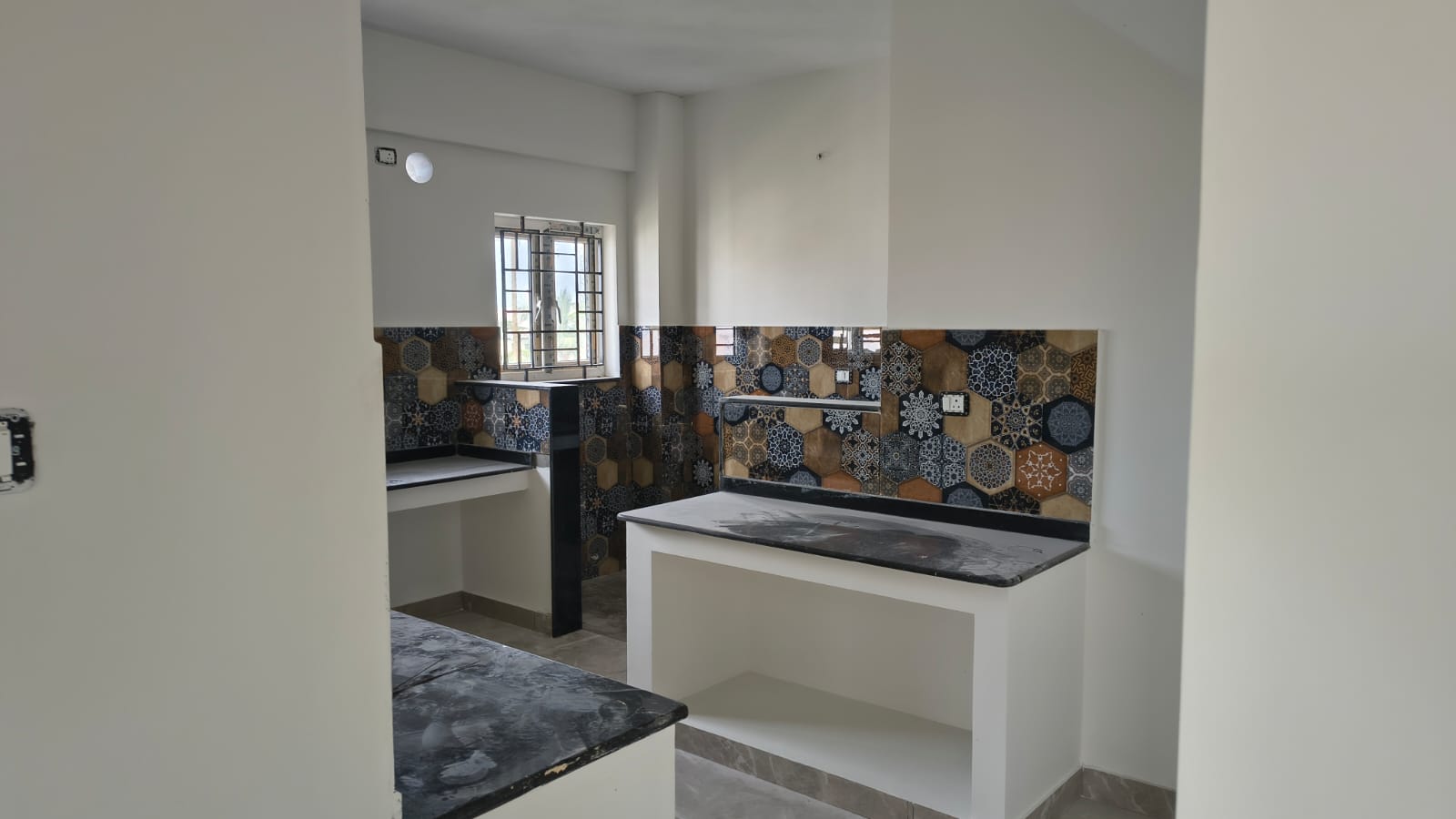

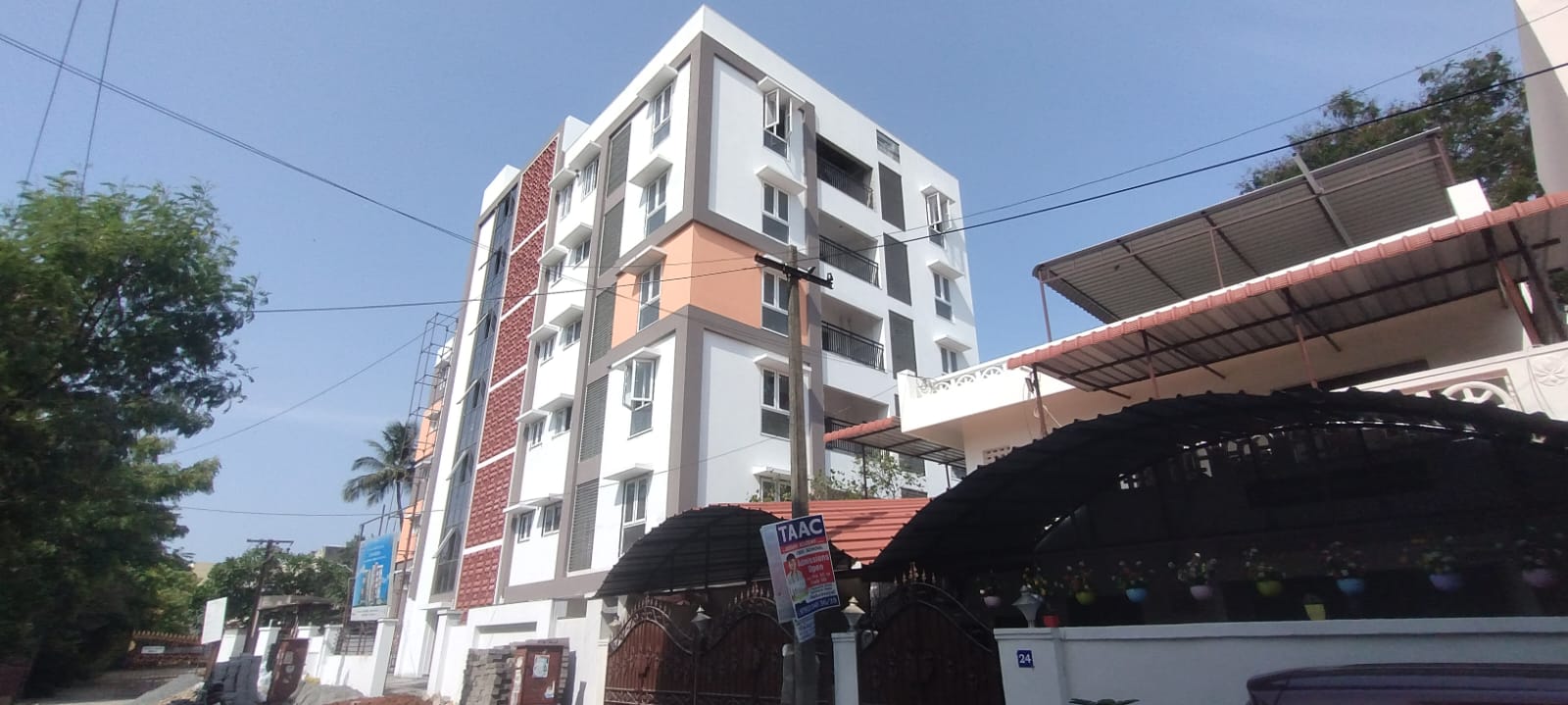

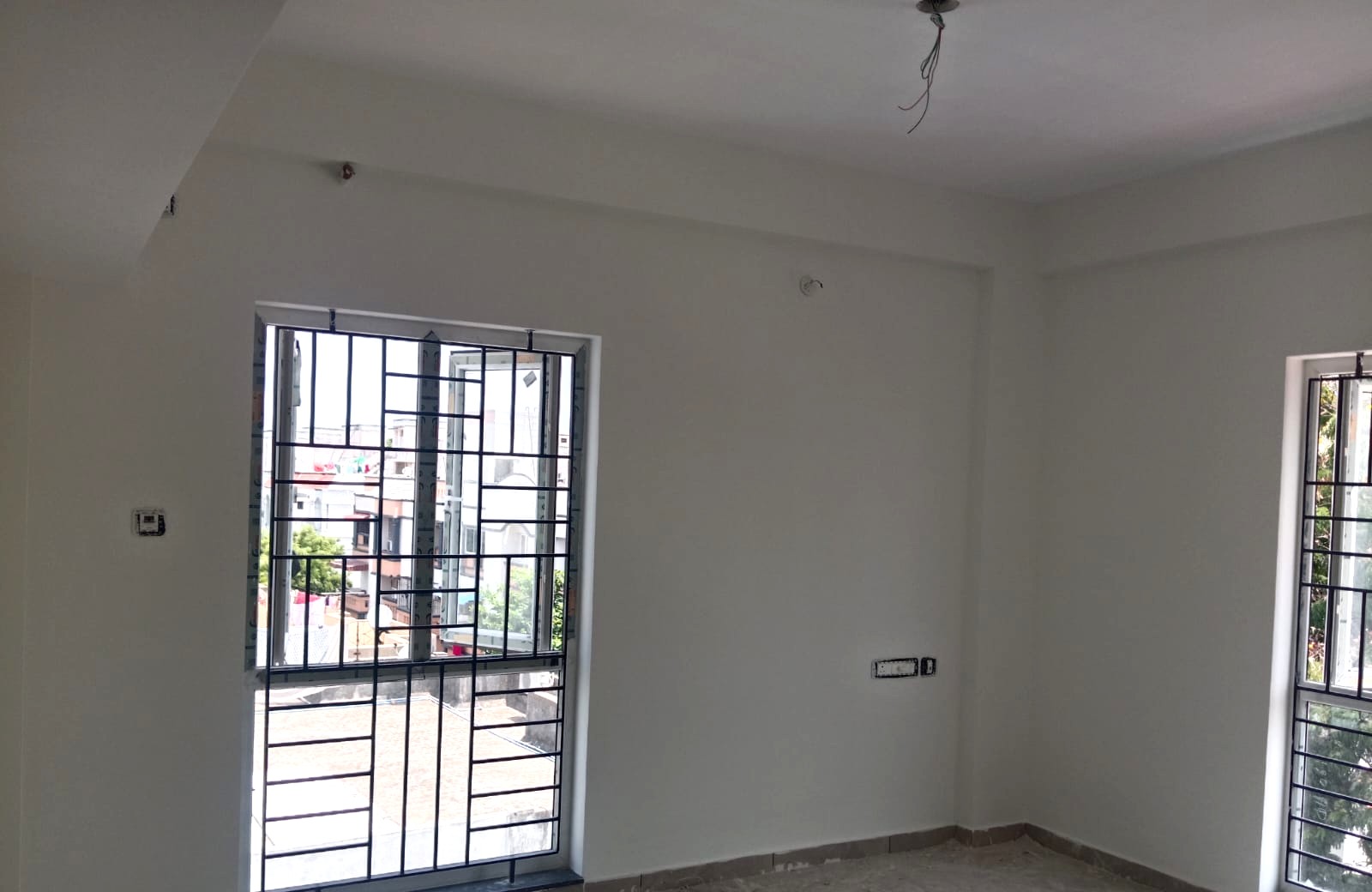

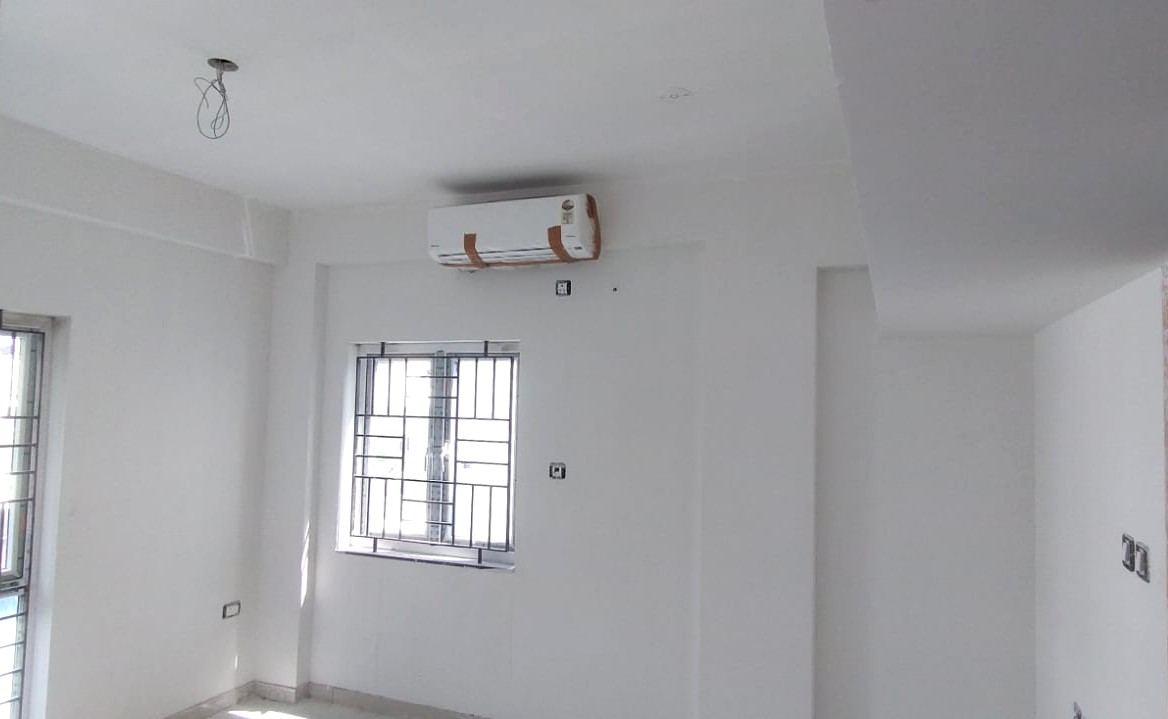

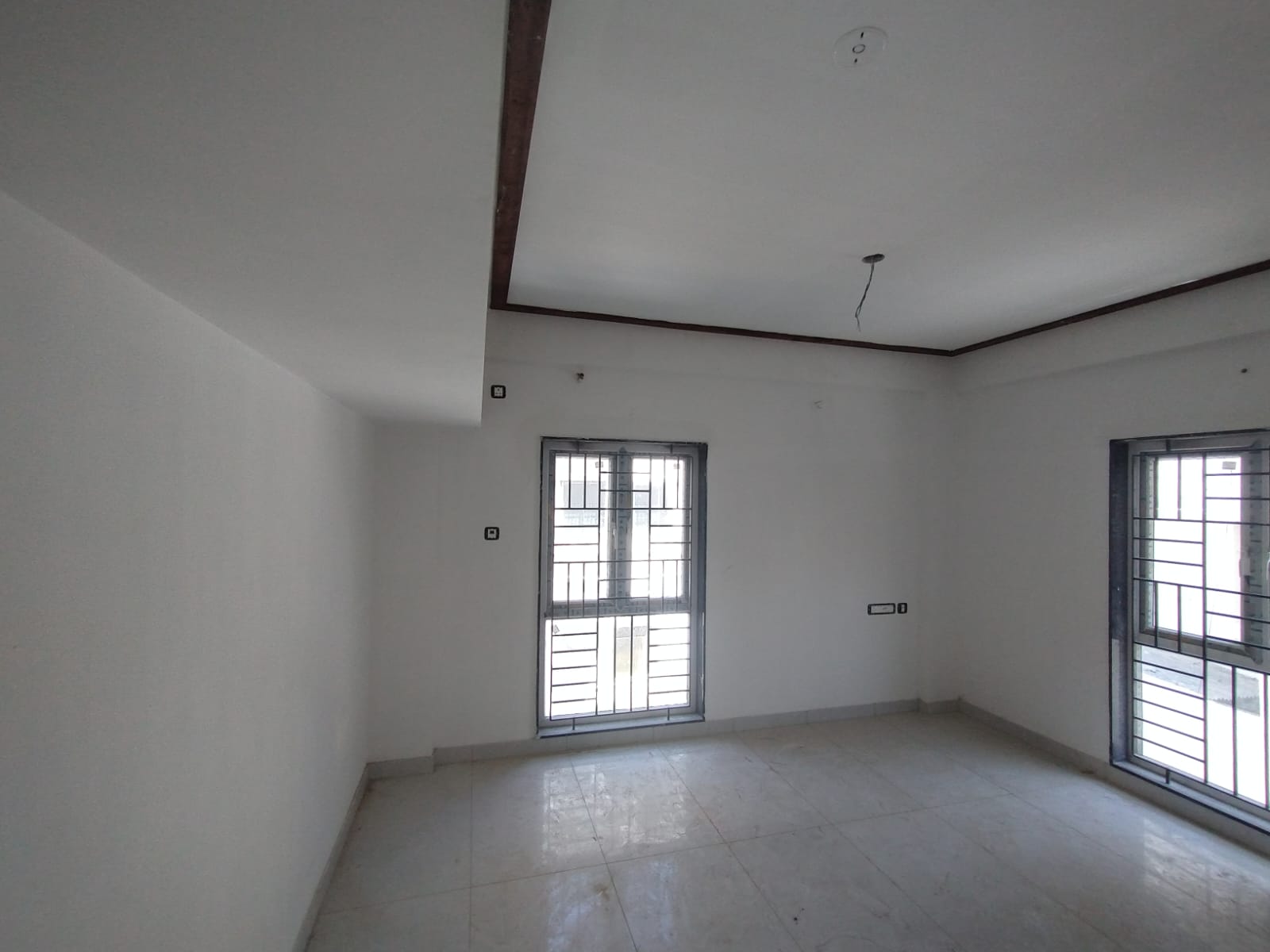

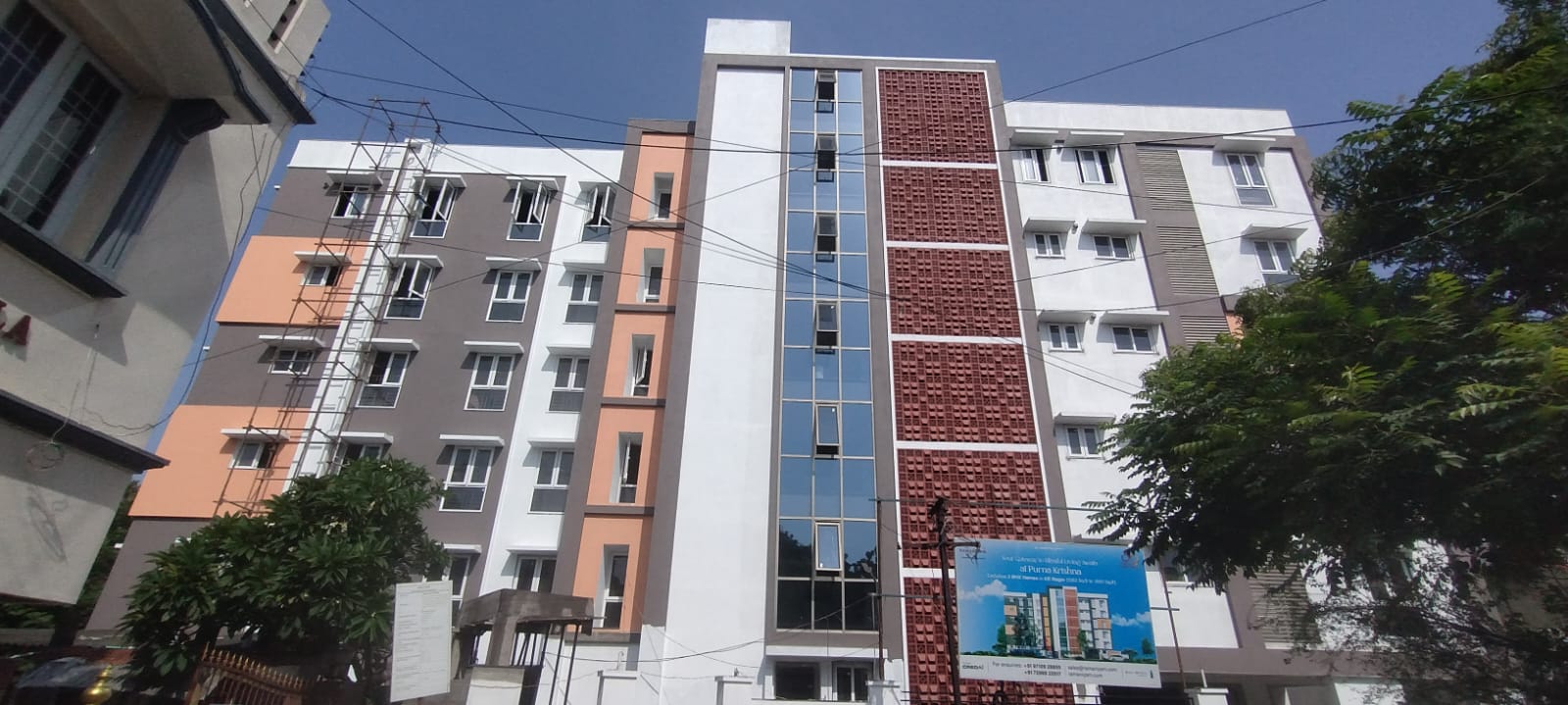

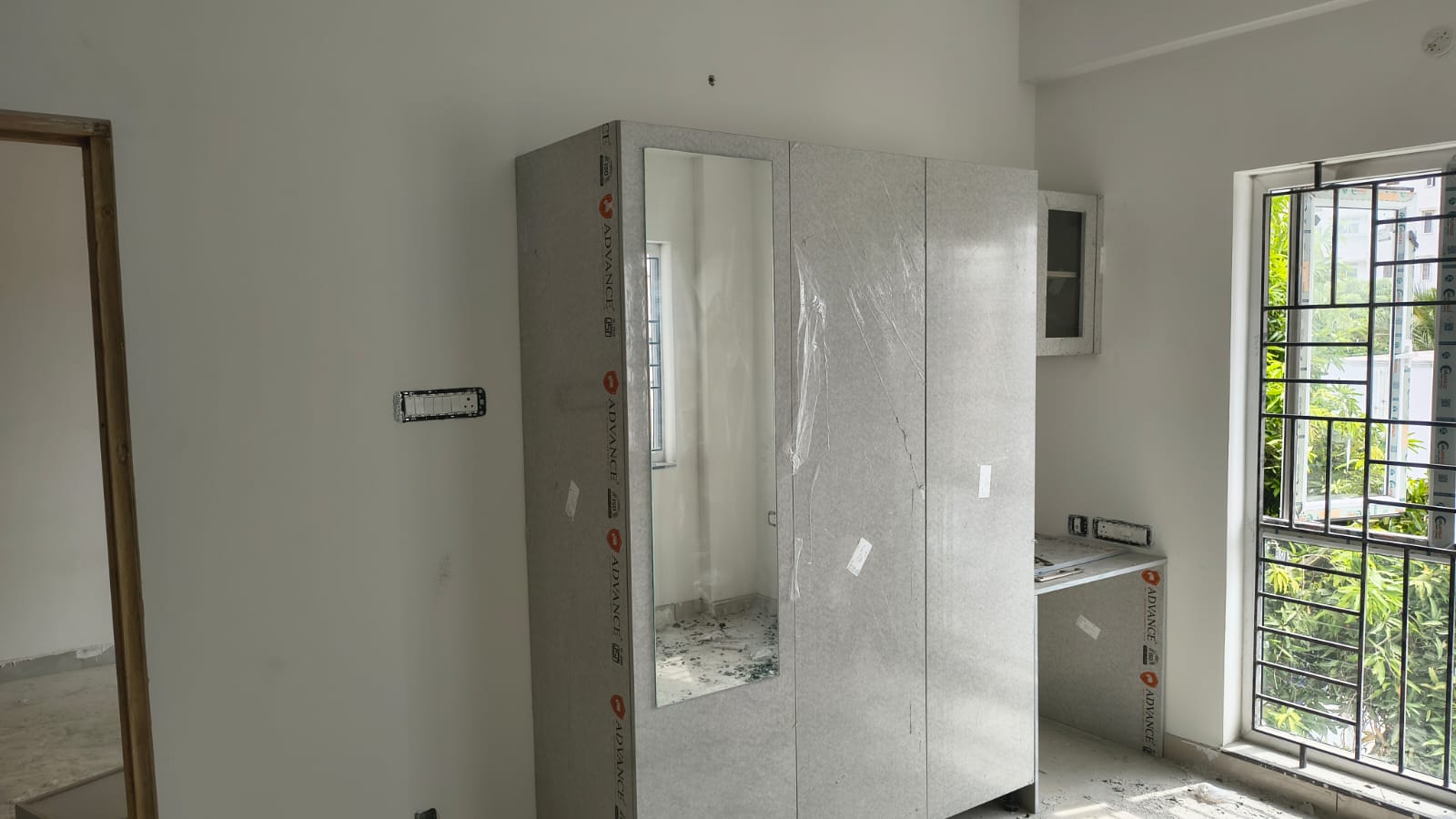

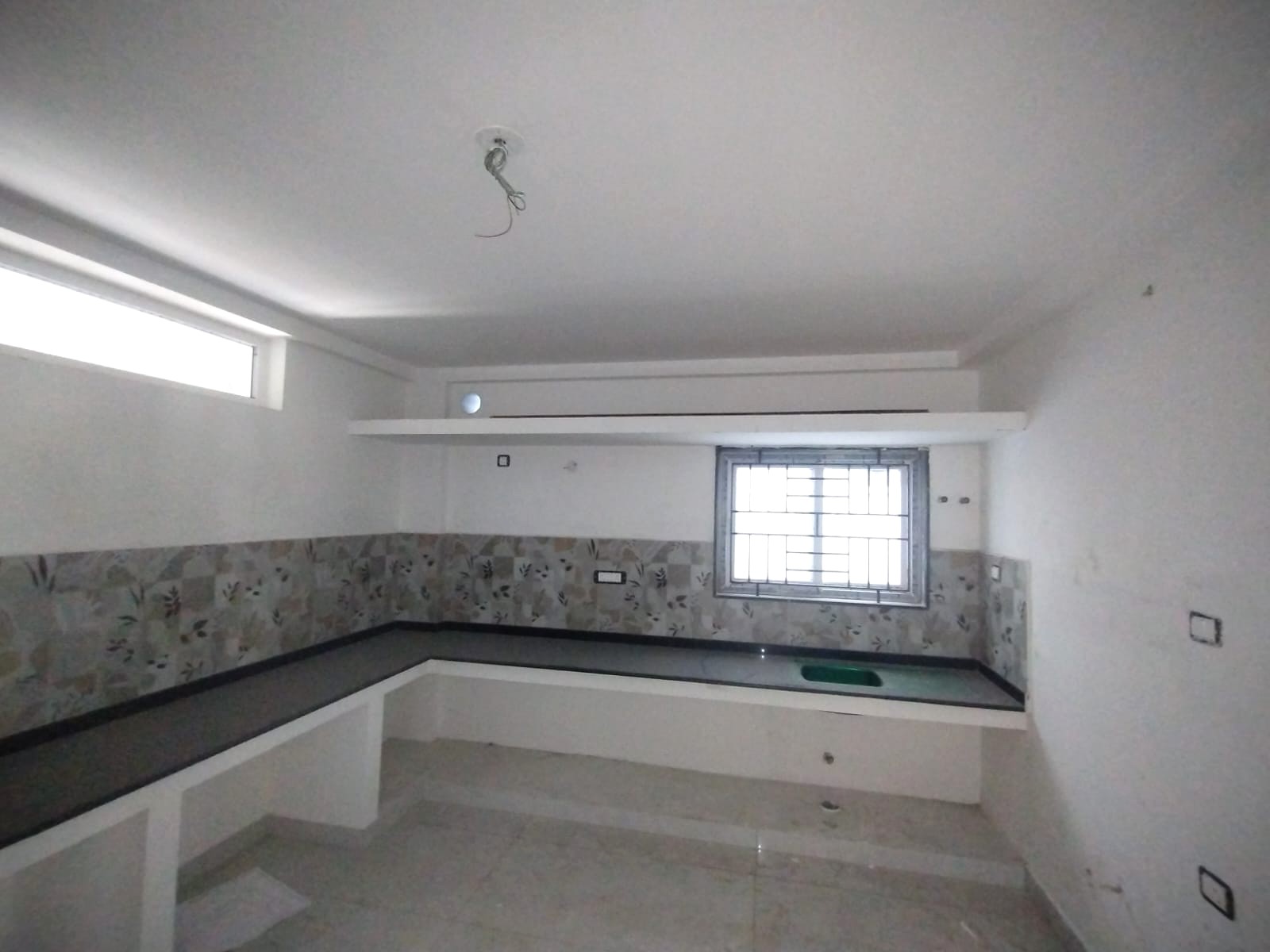

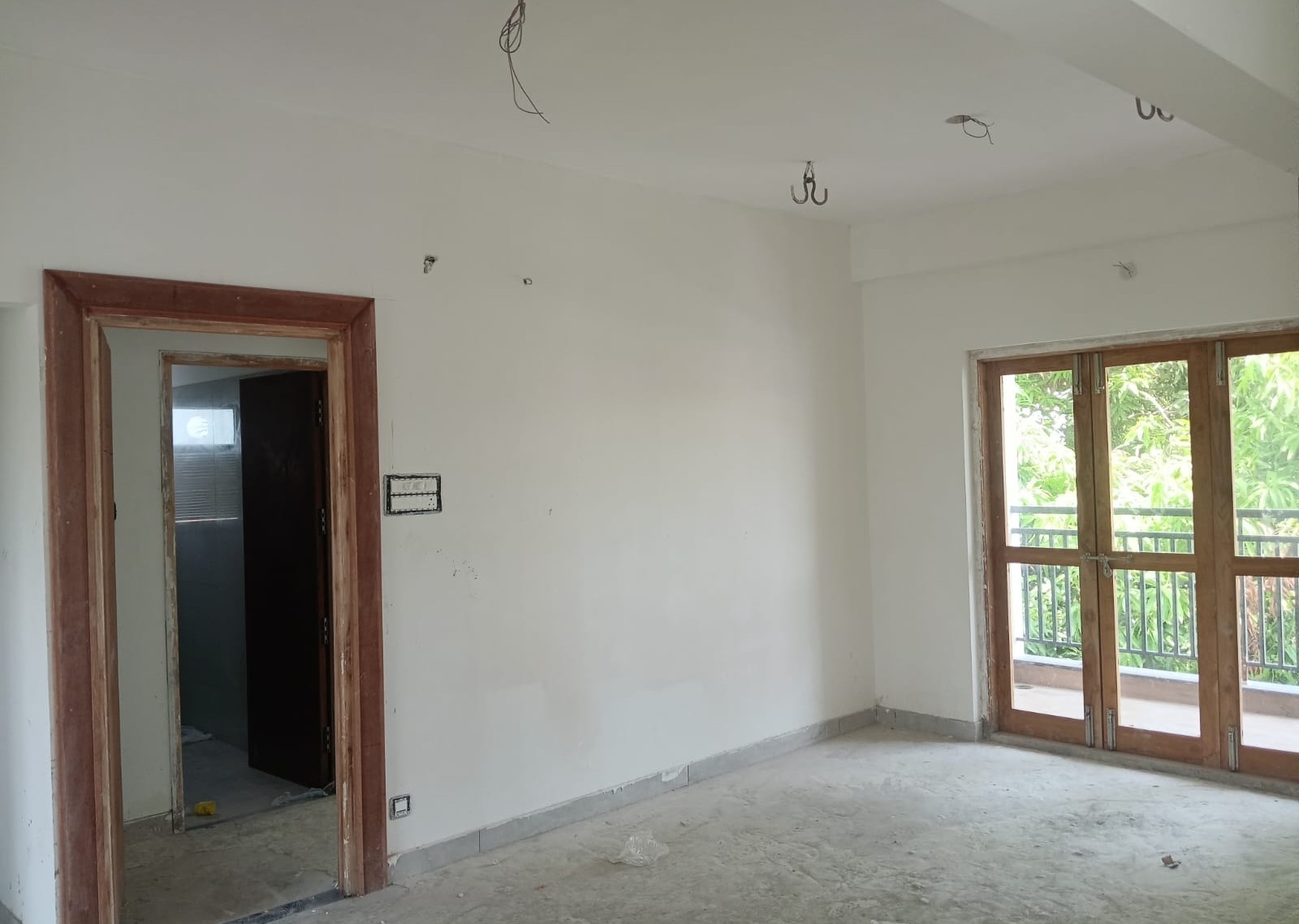

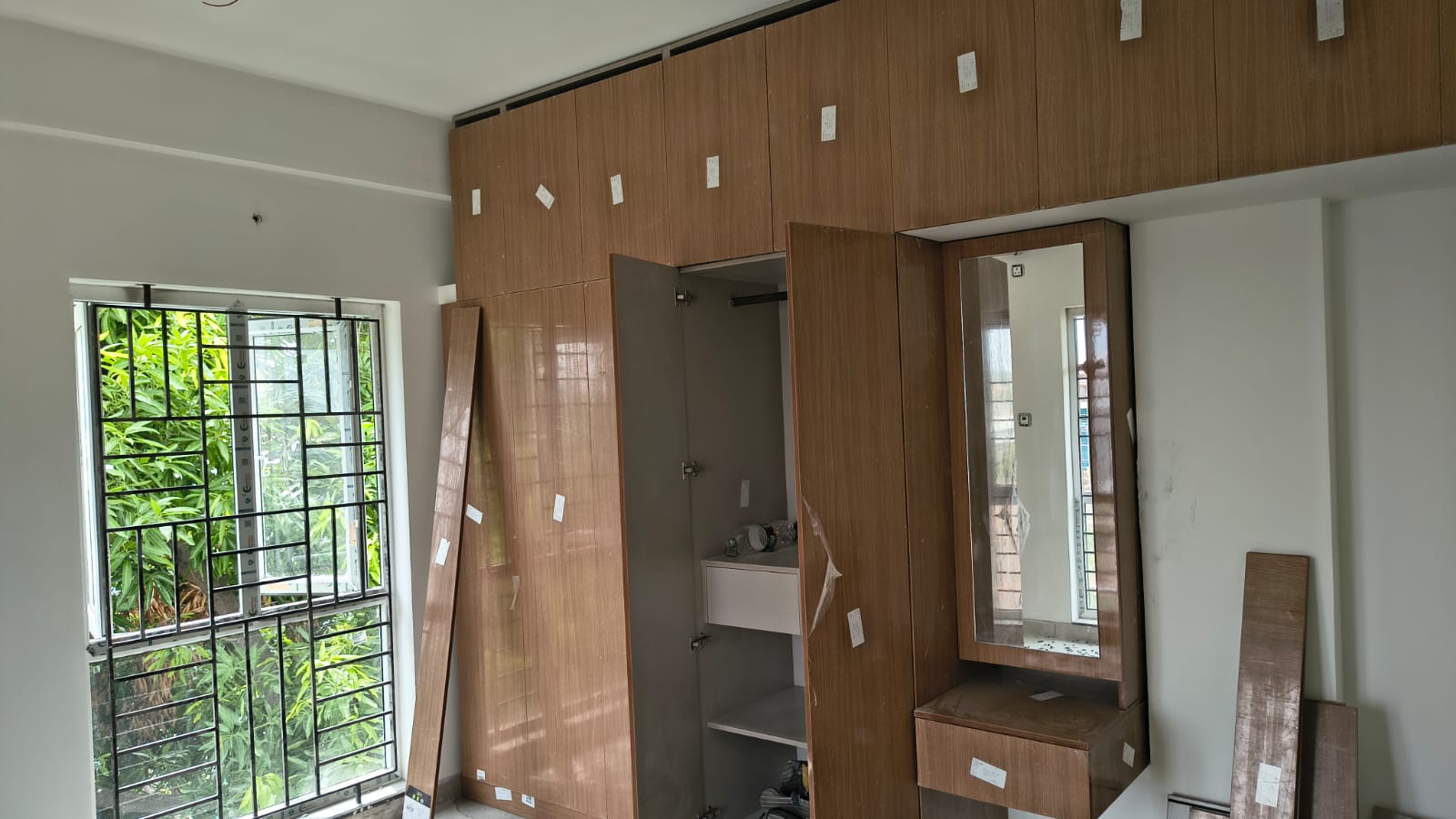

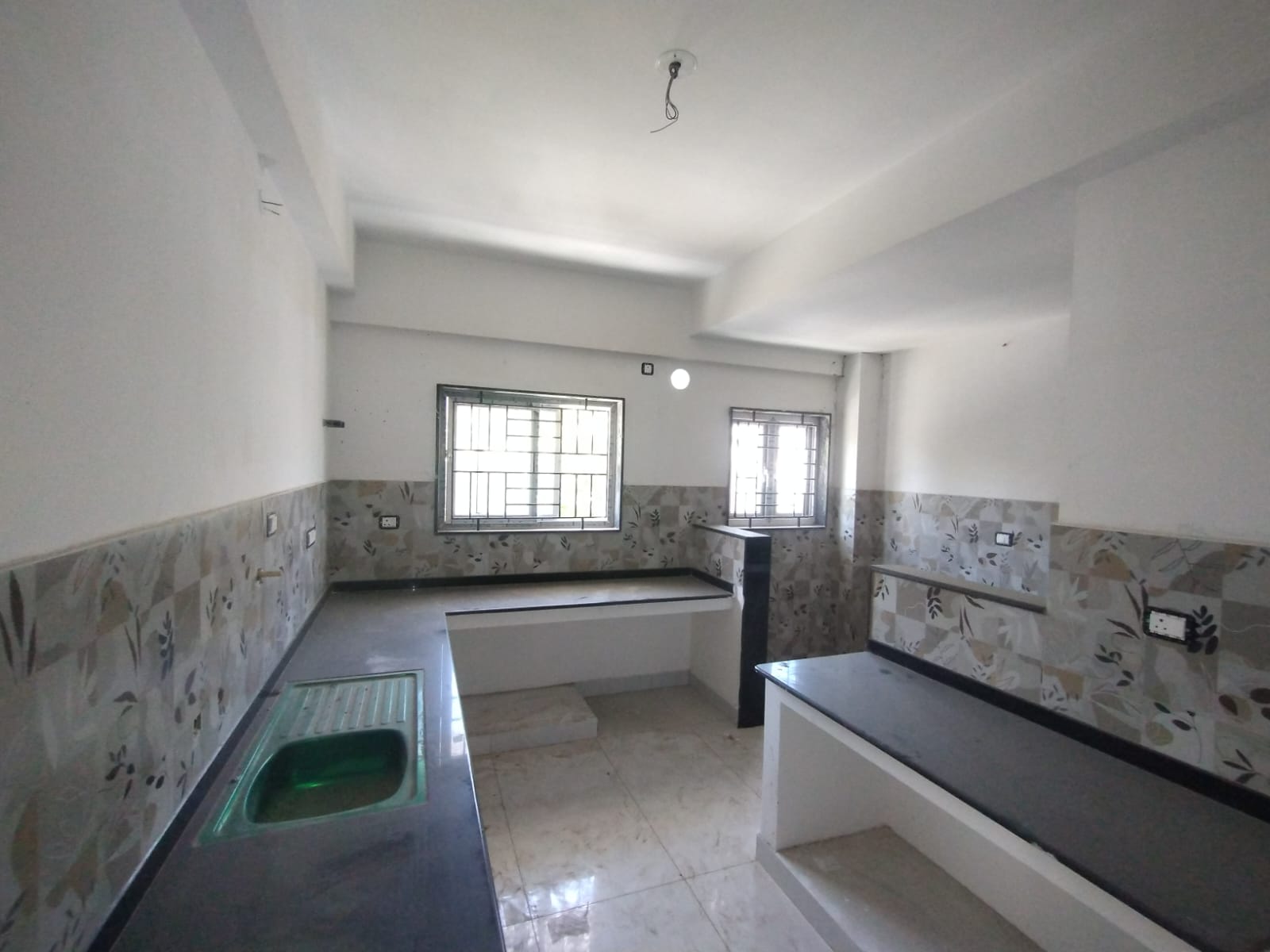

Project Update Images

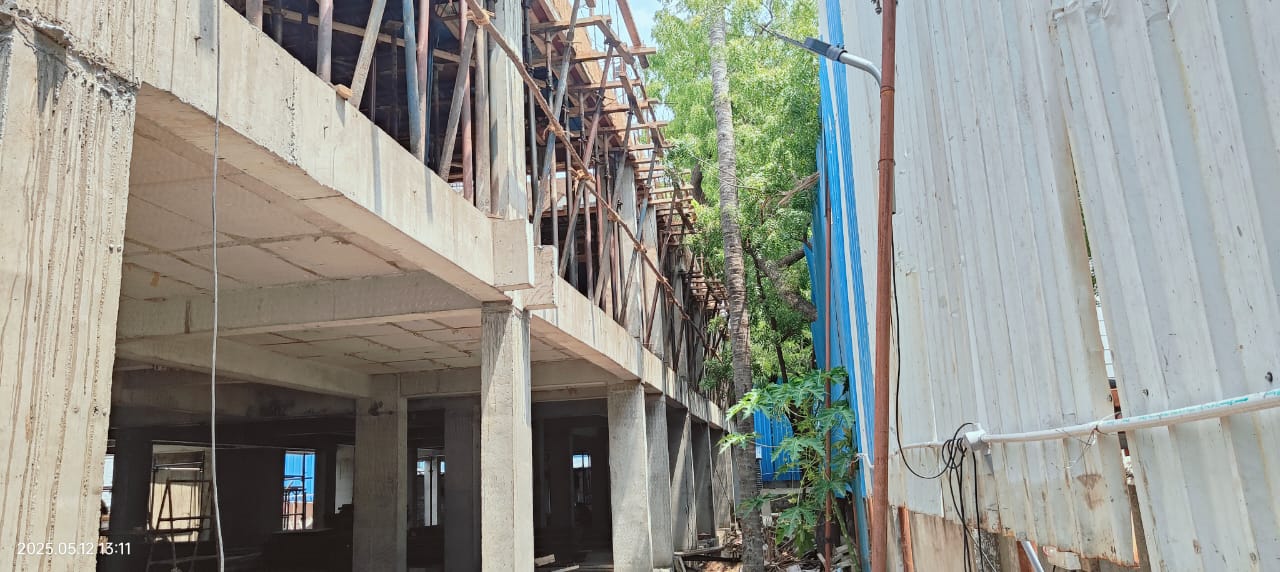

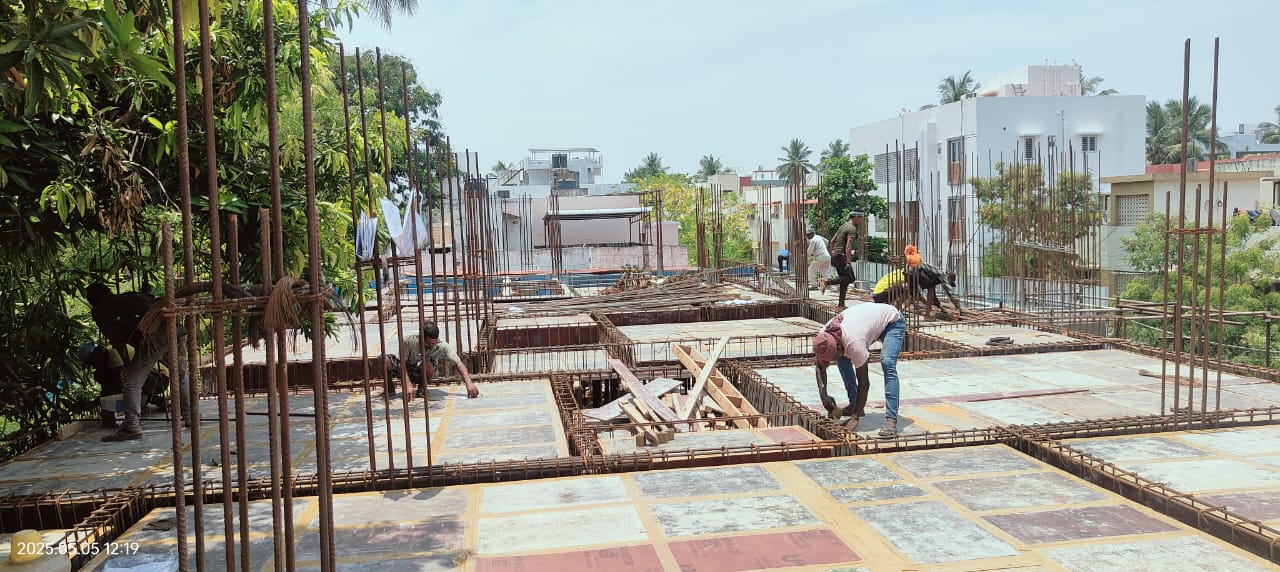

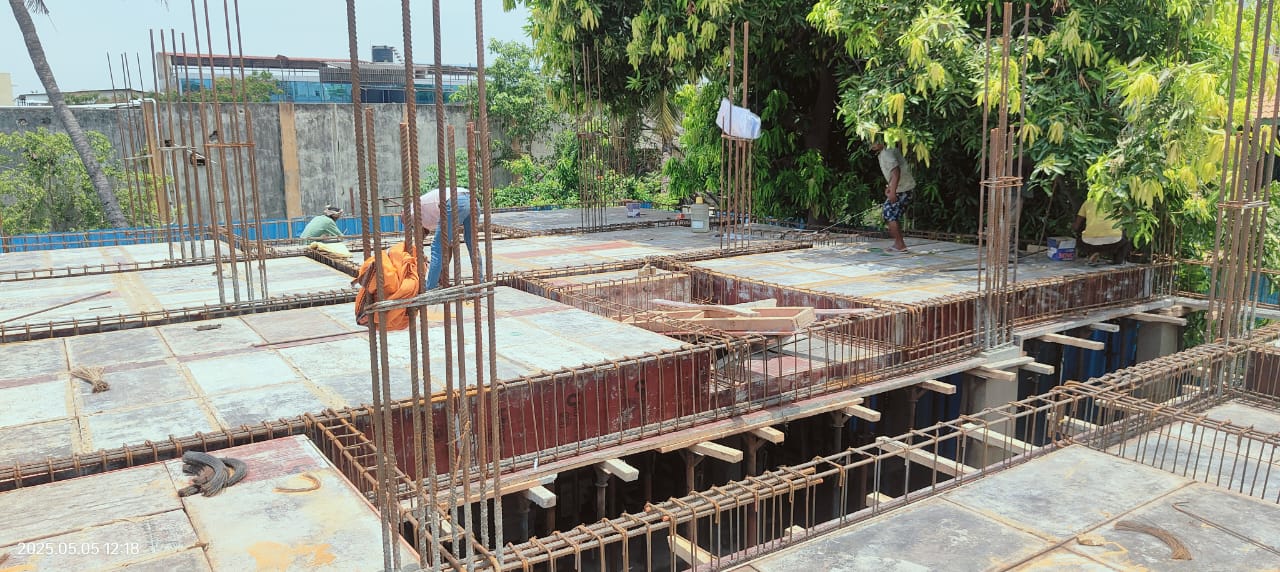

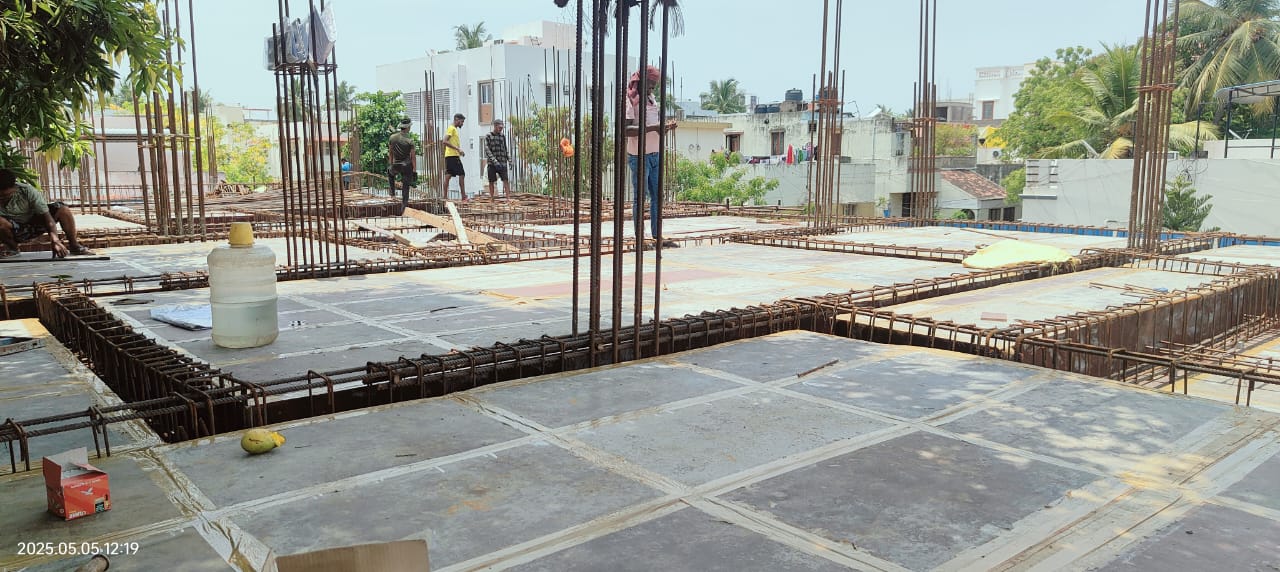

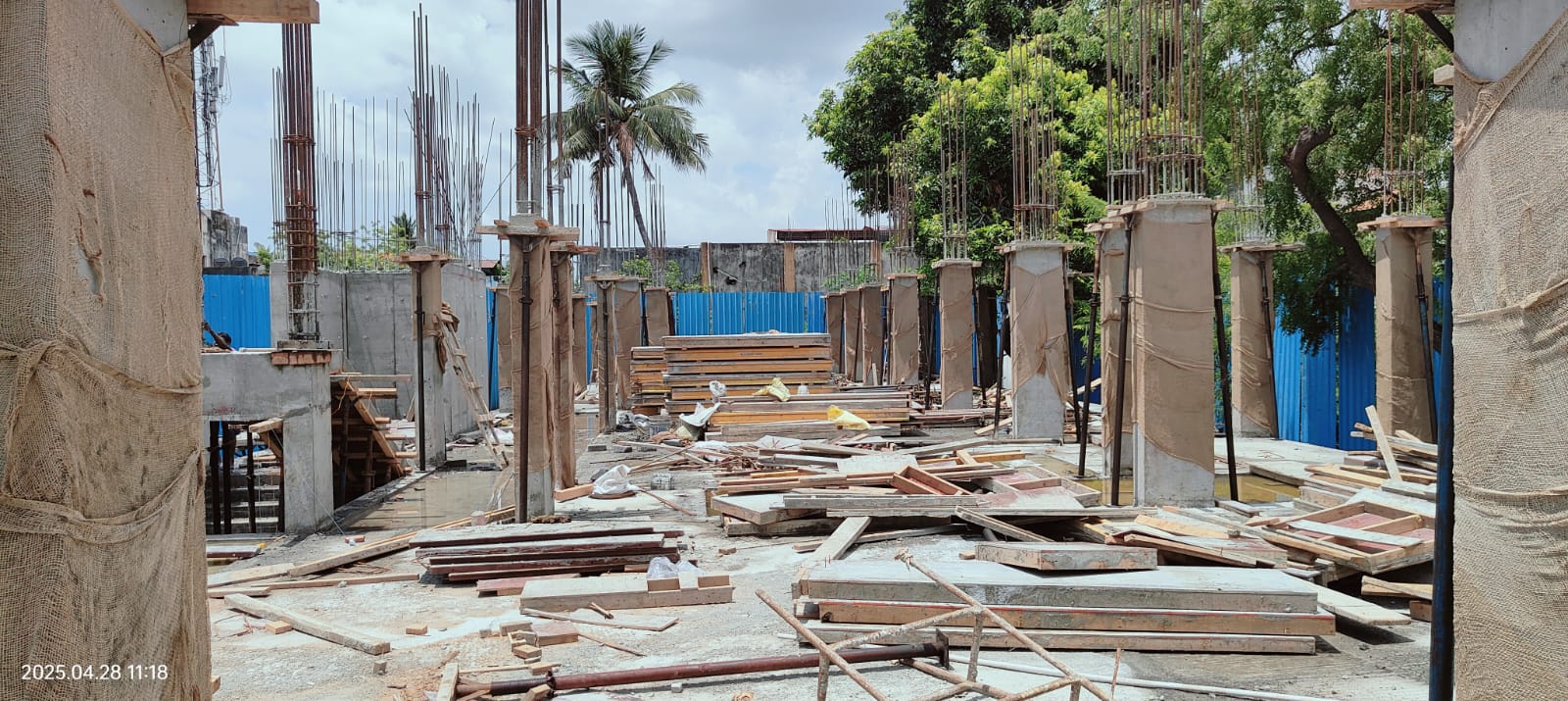

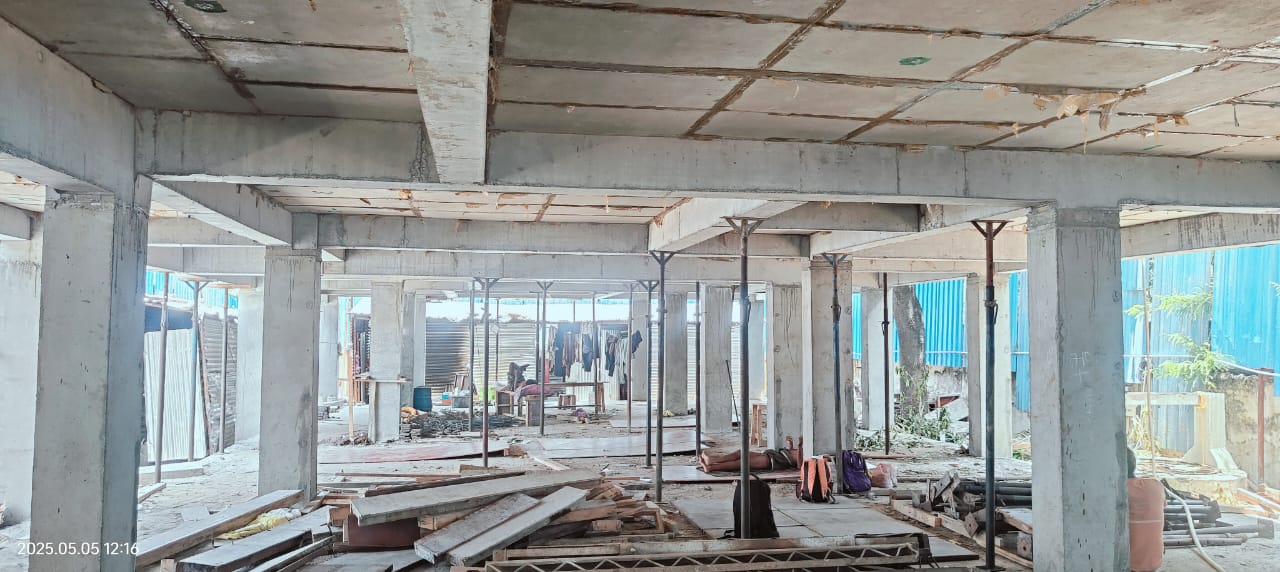

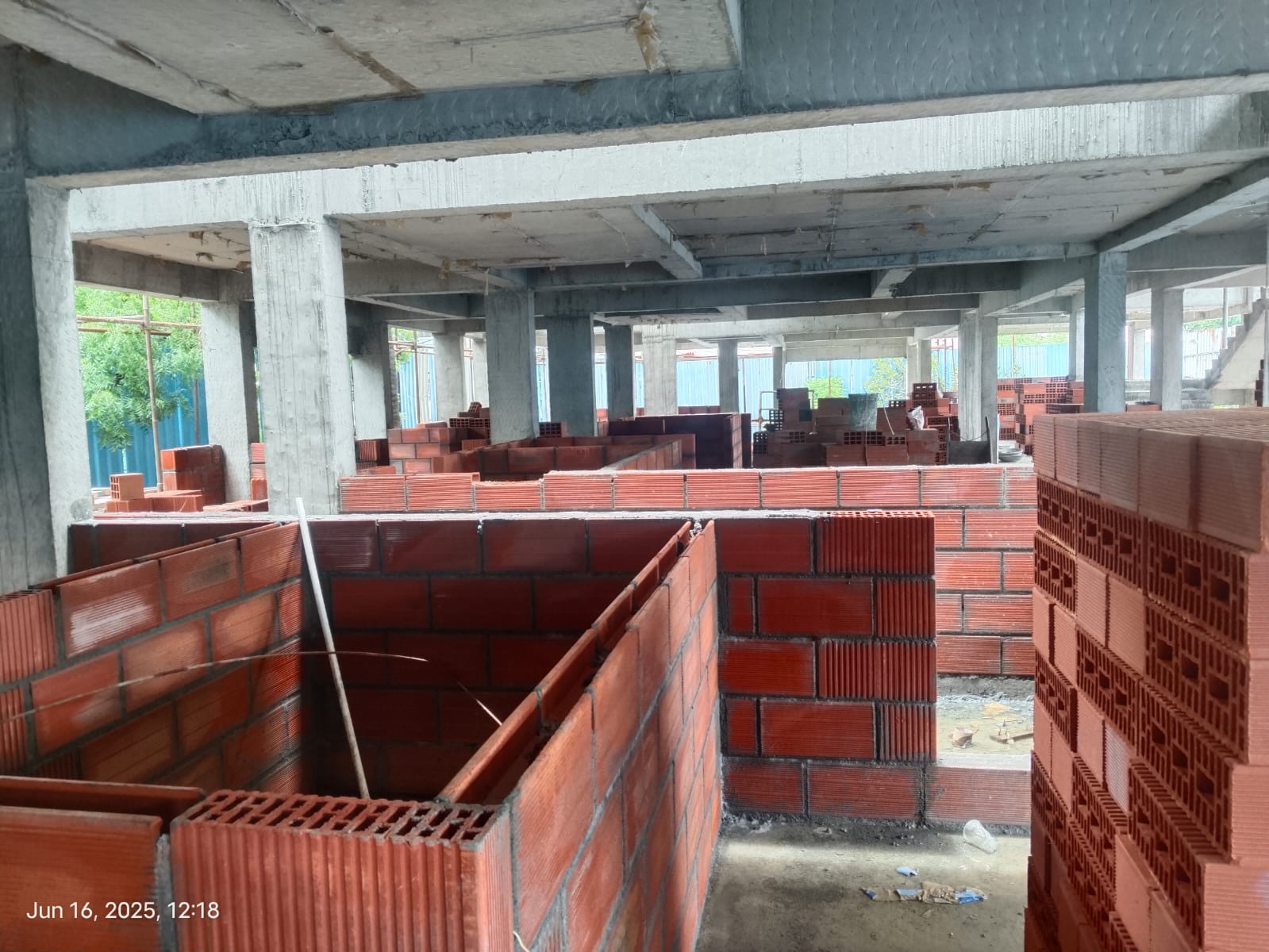

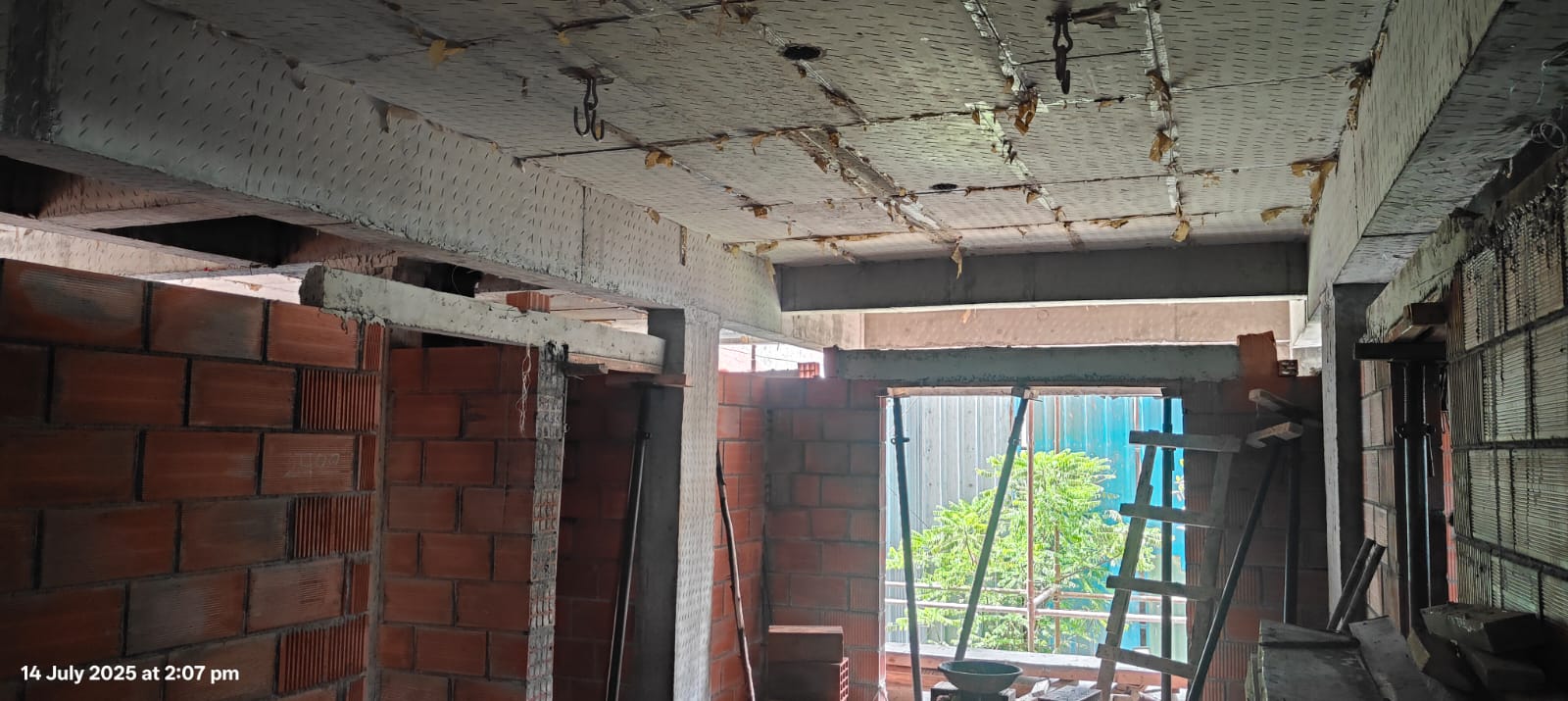

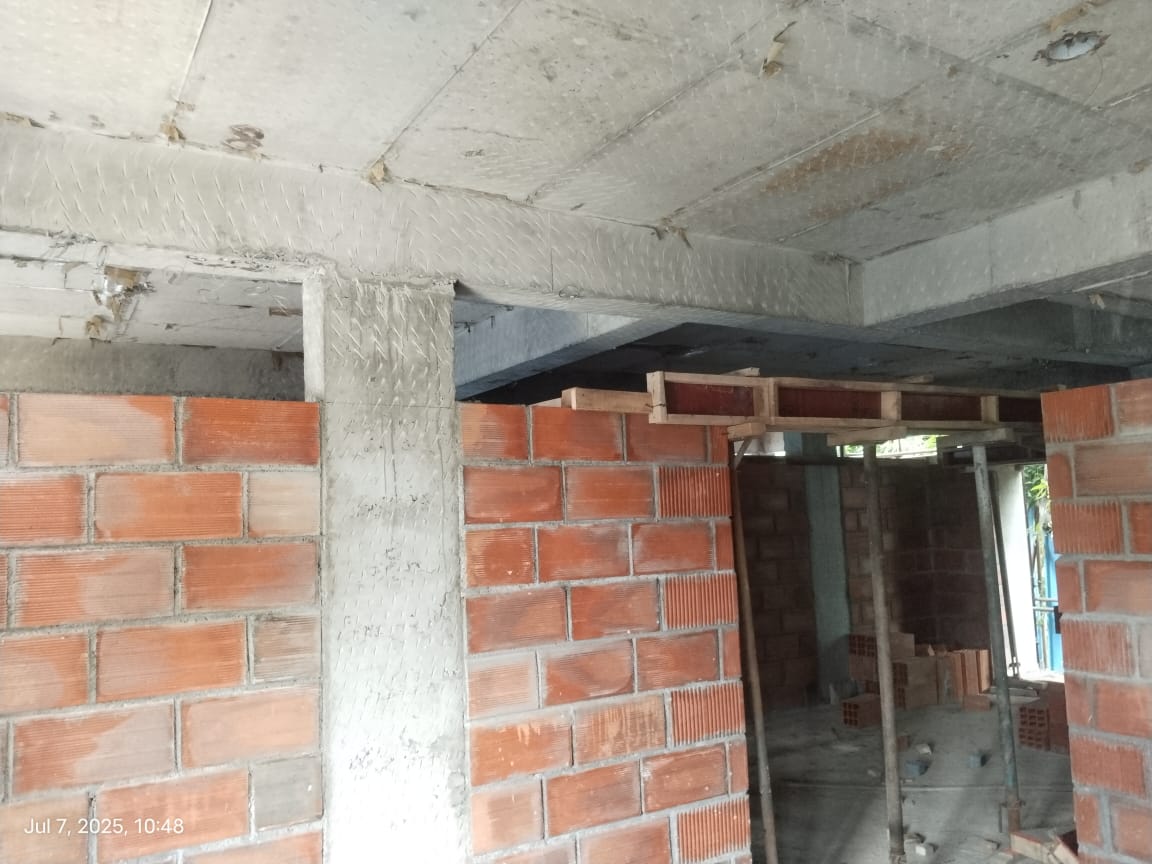

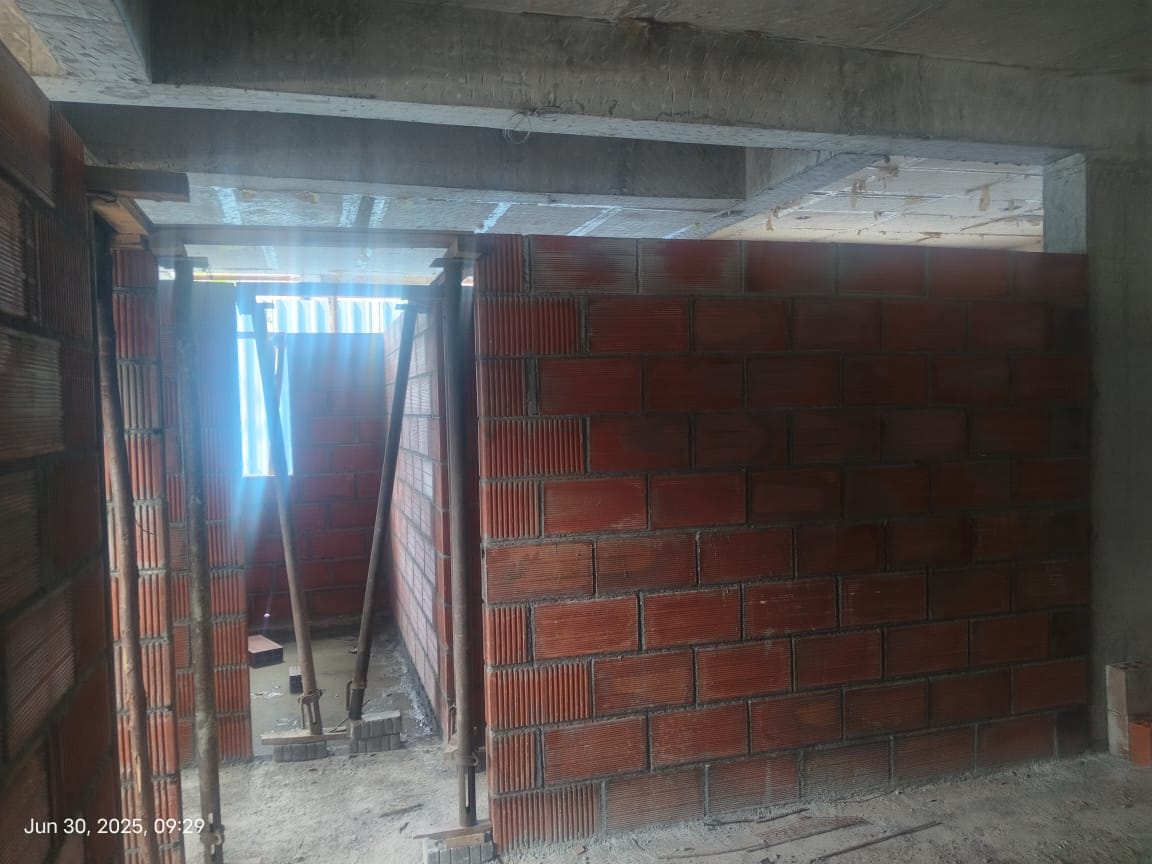

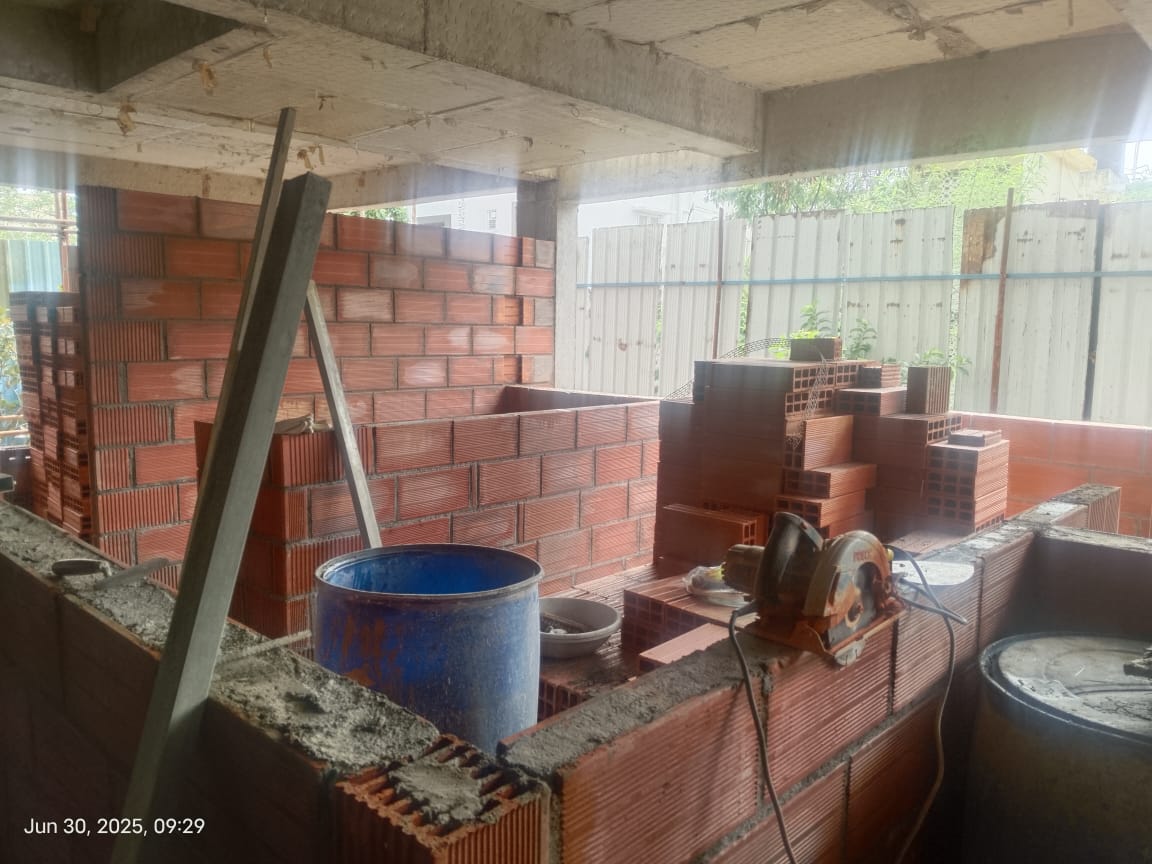

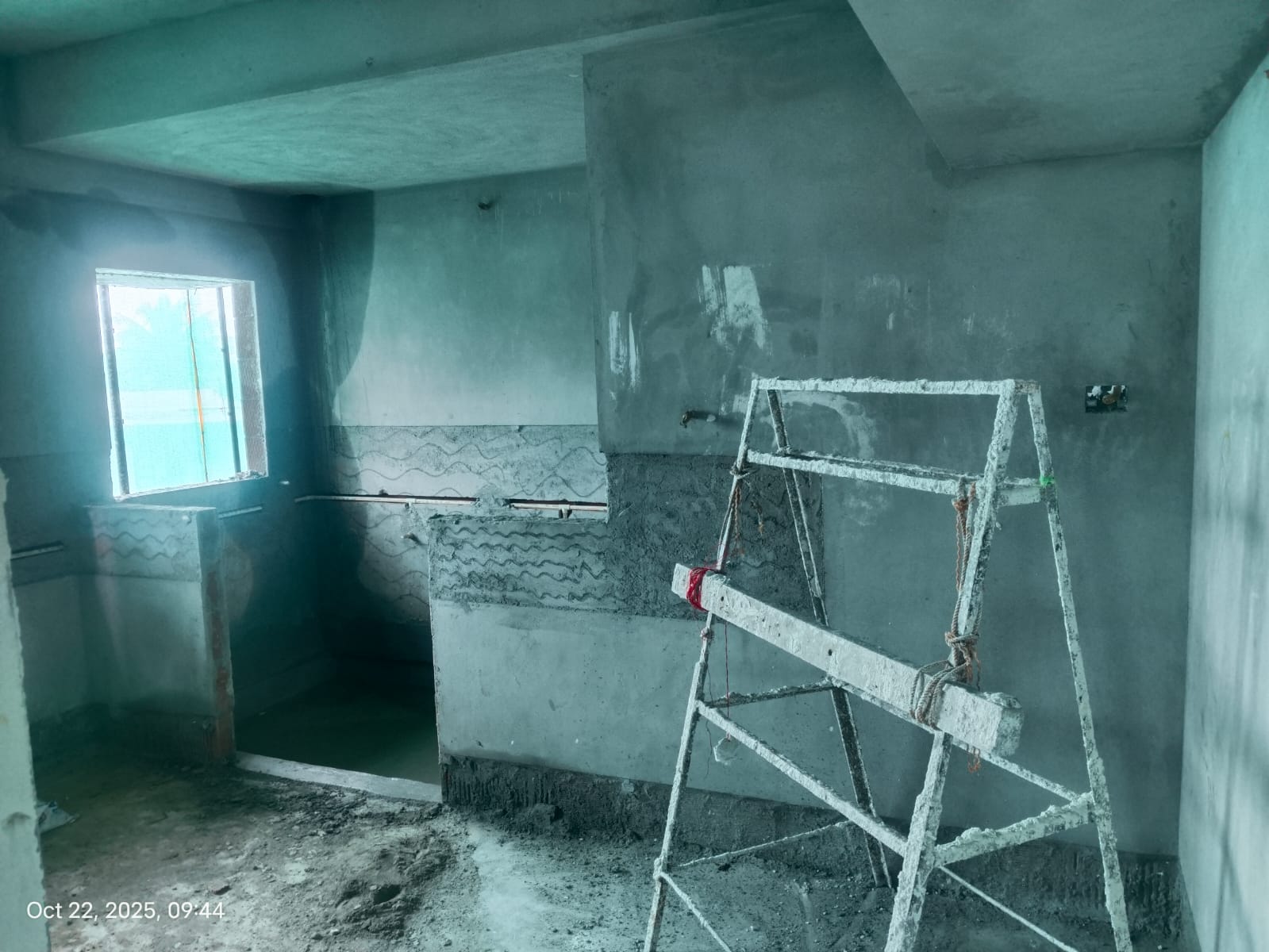

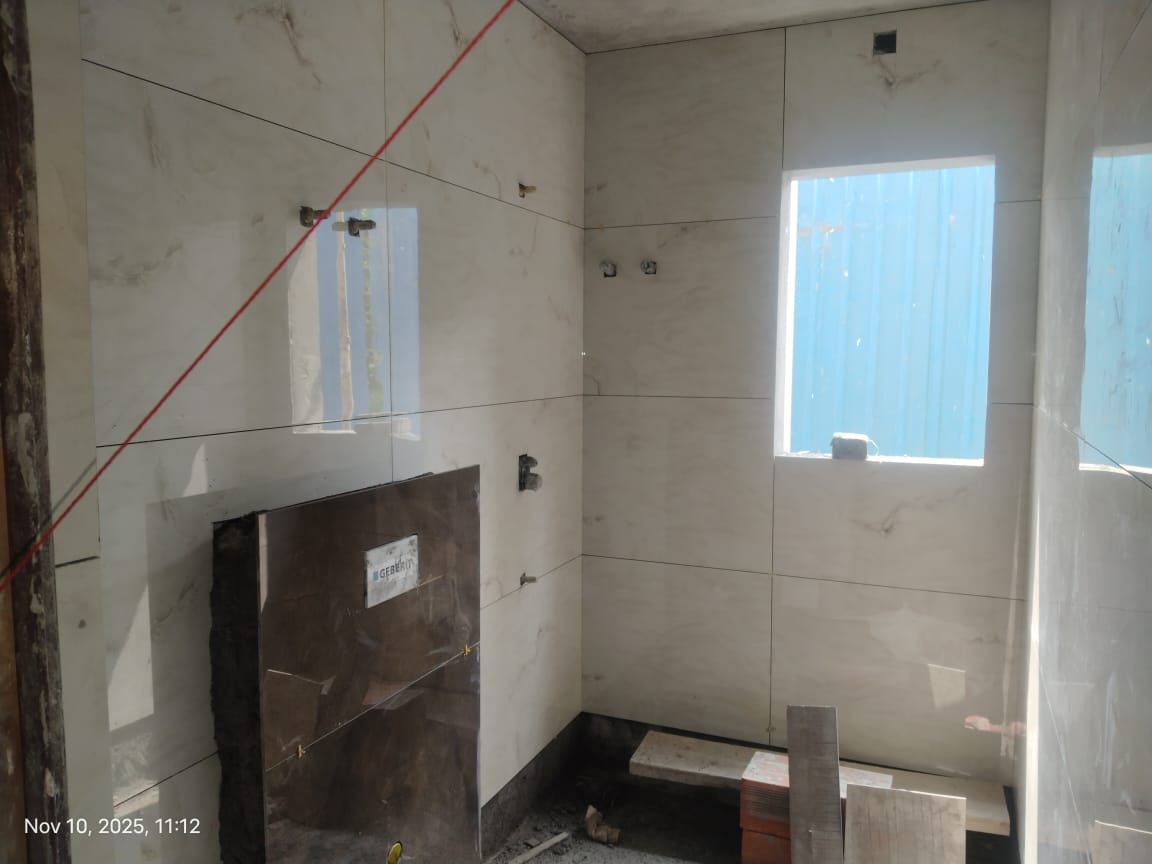

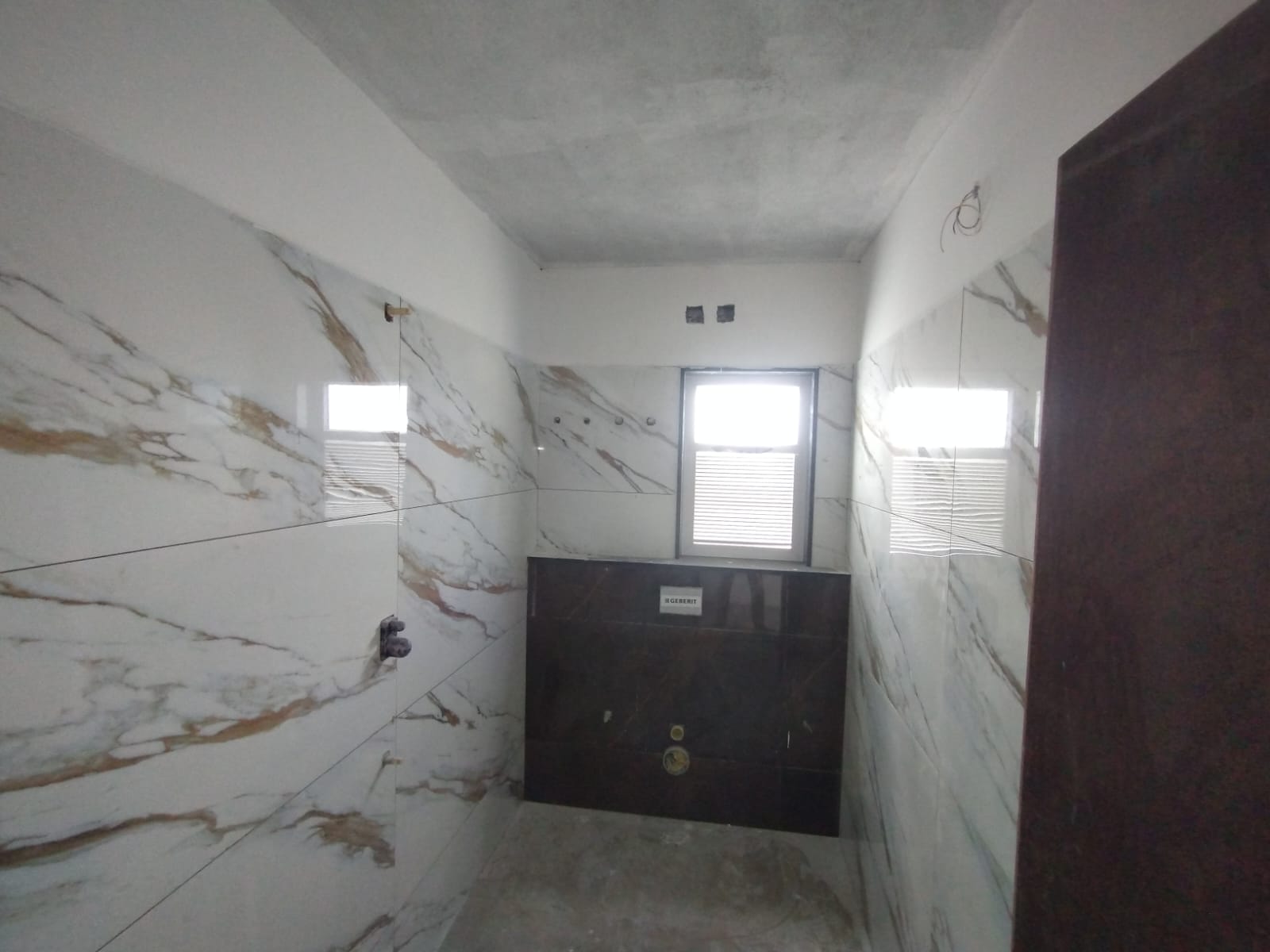

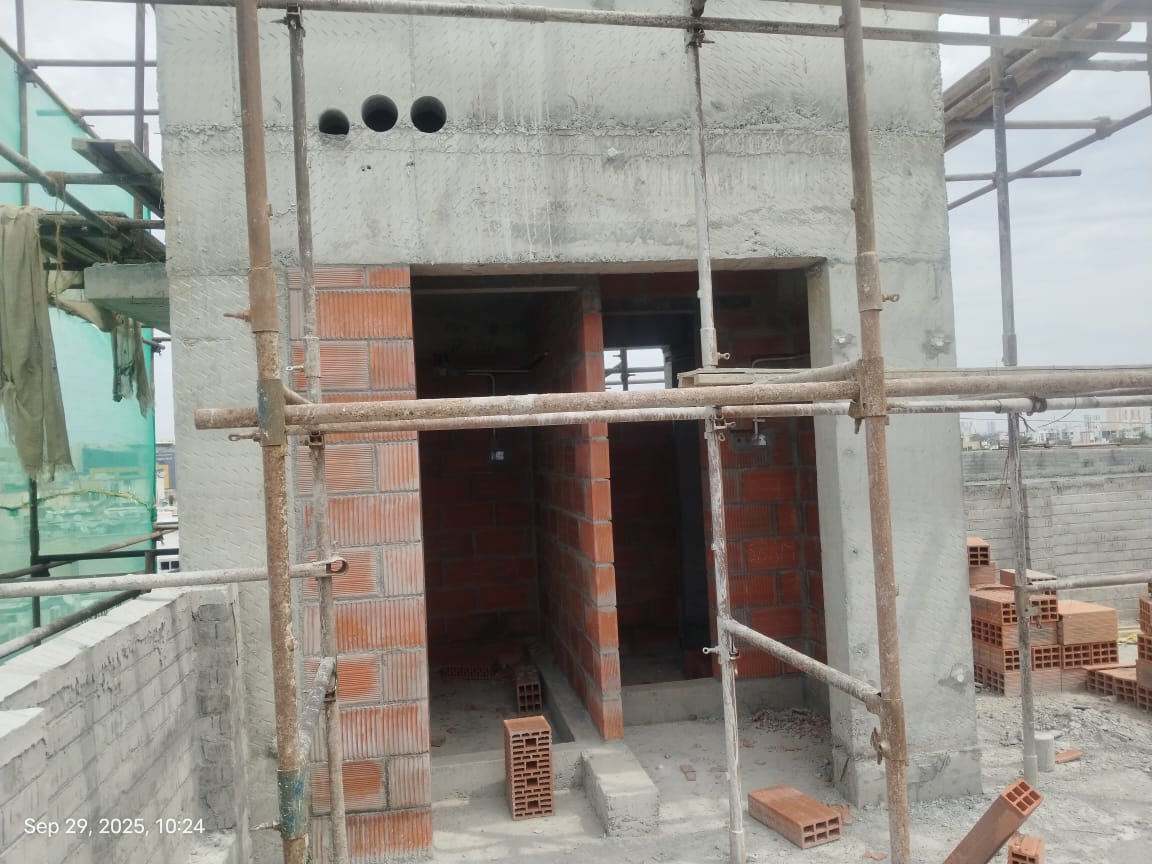

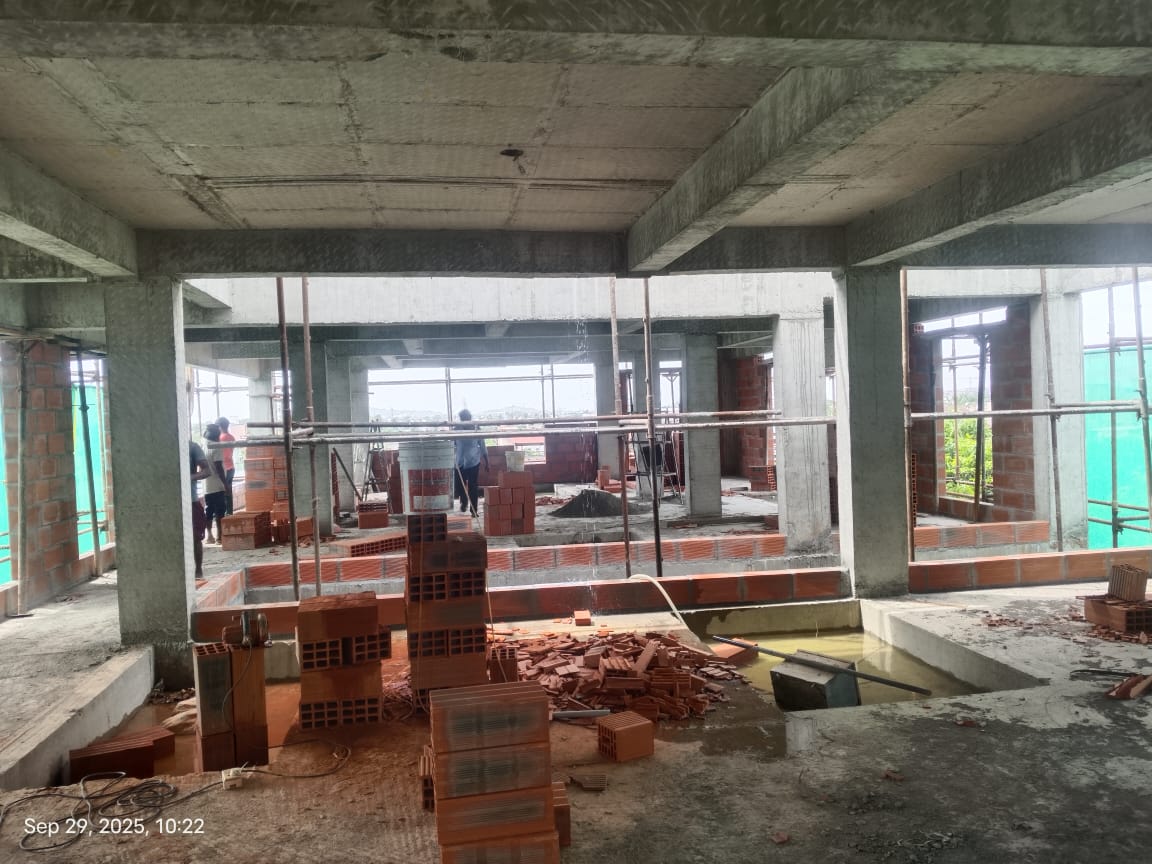

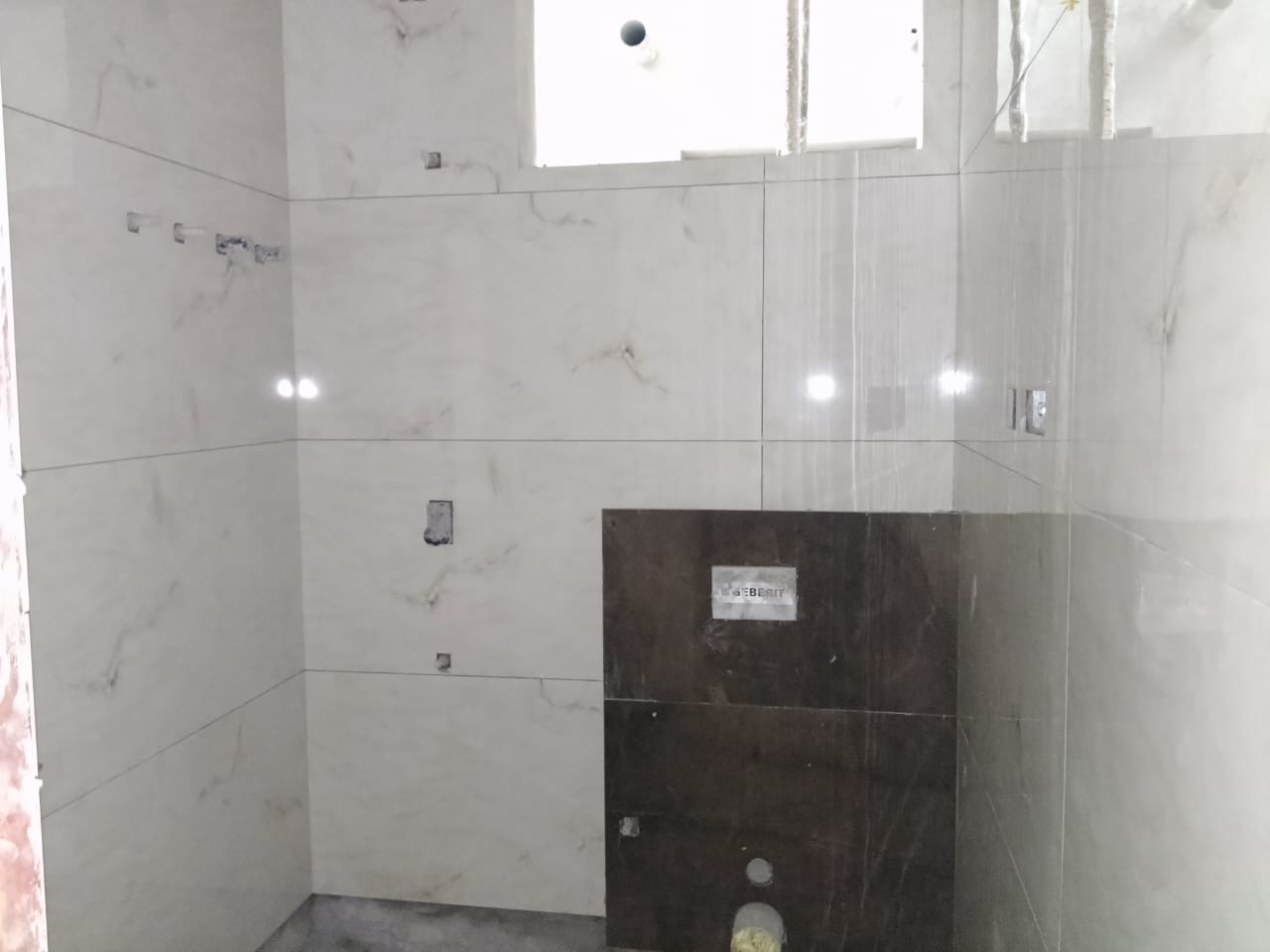

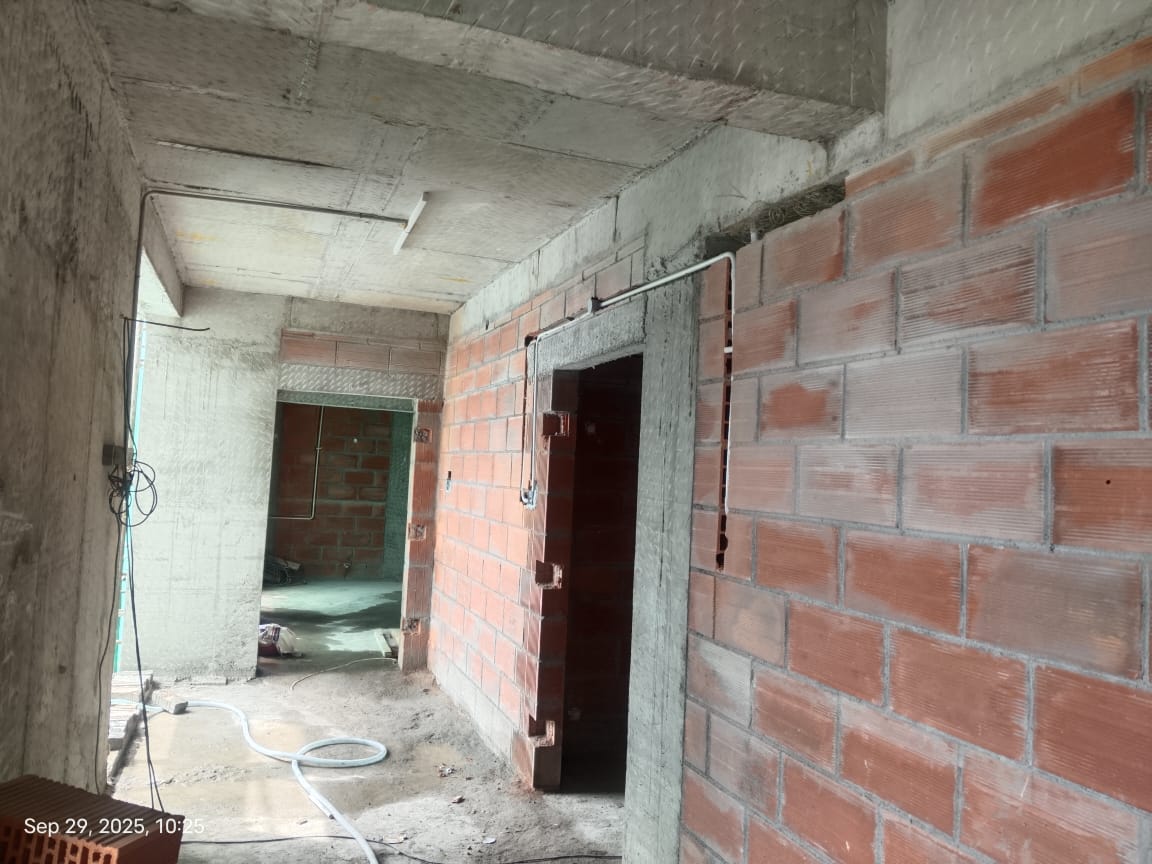

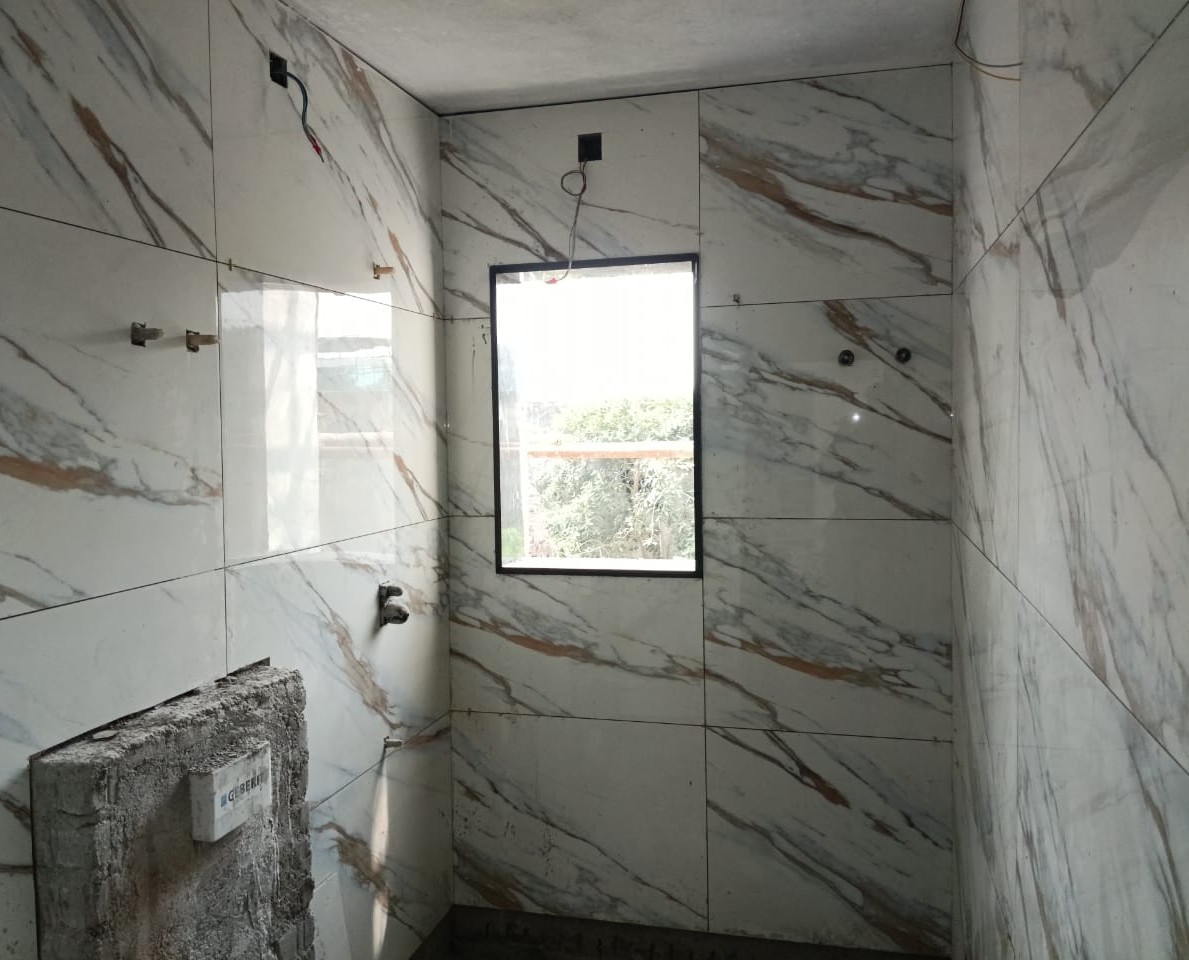

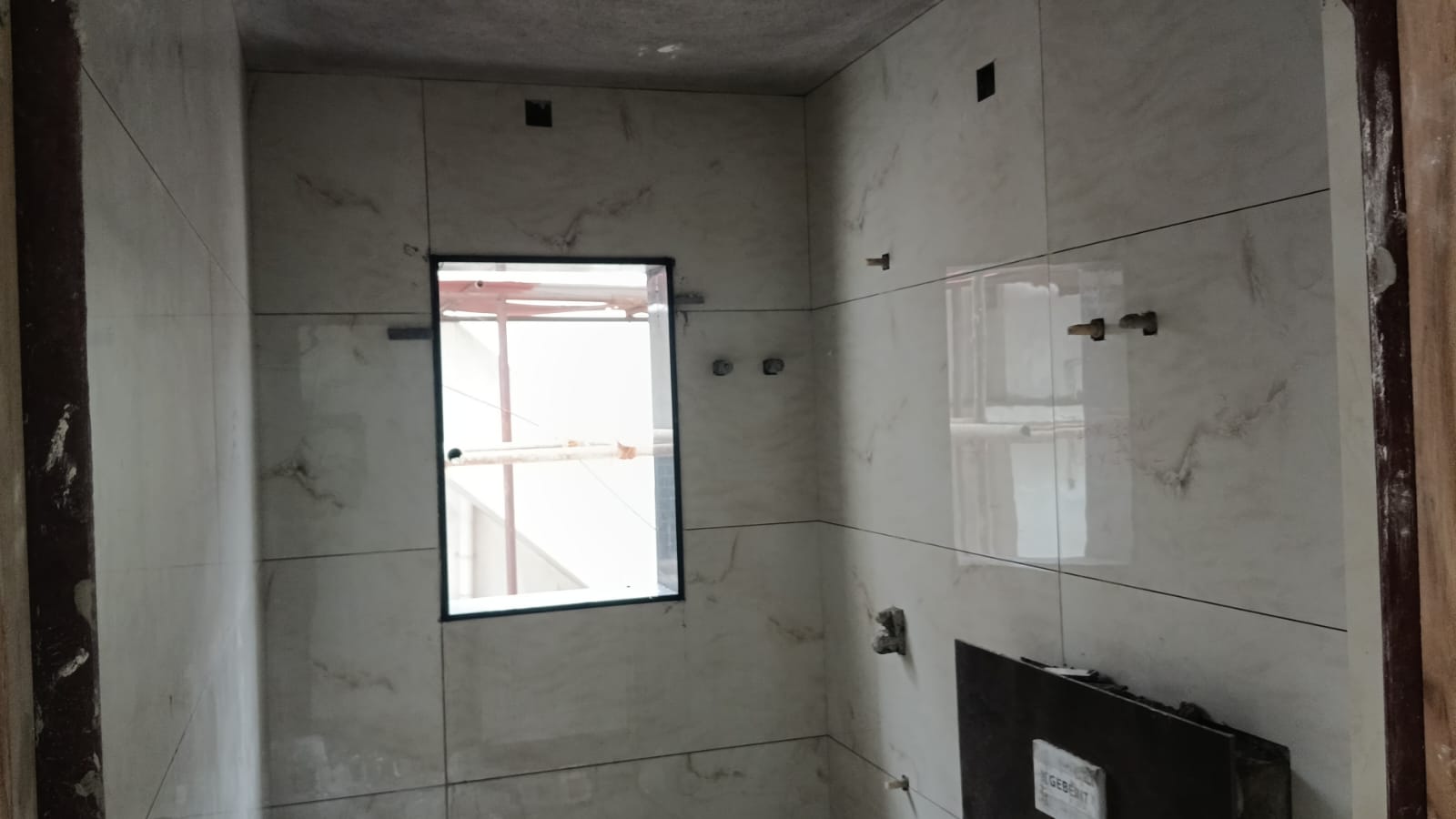

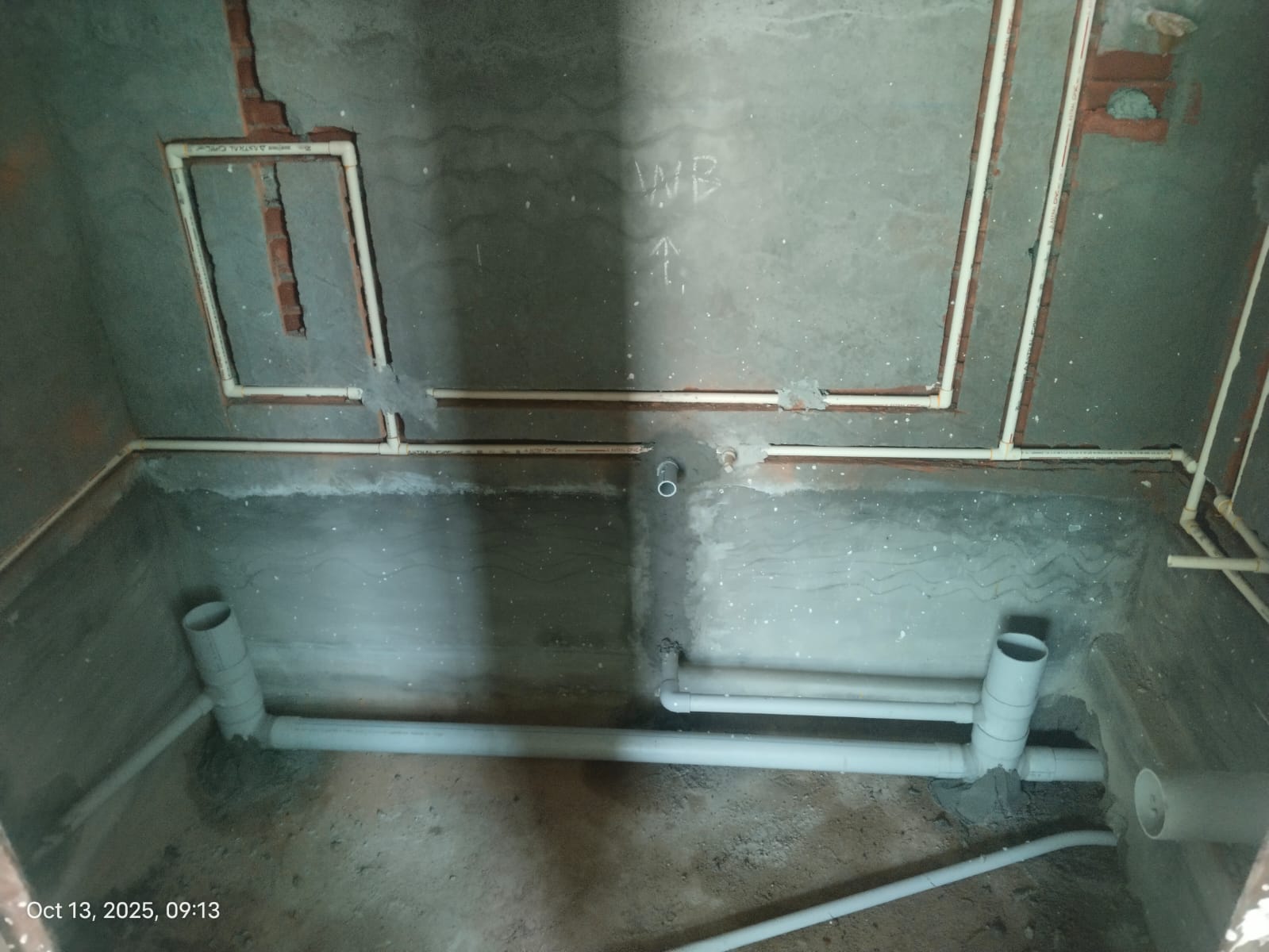

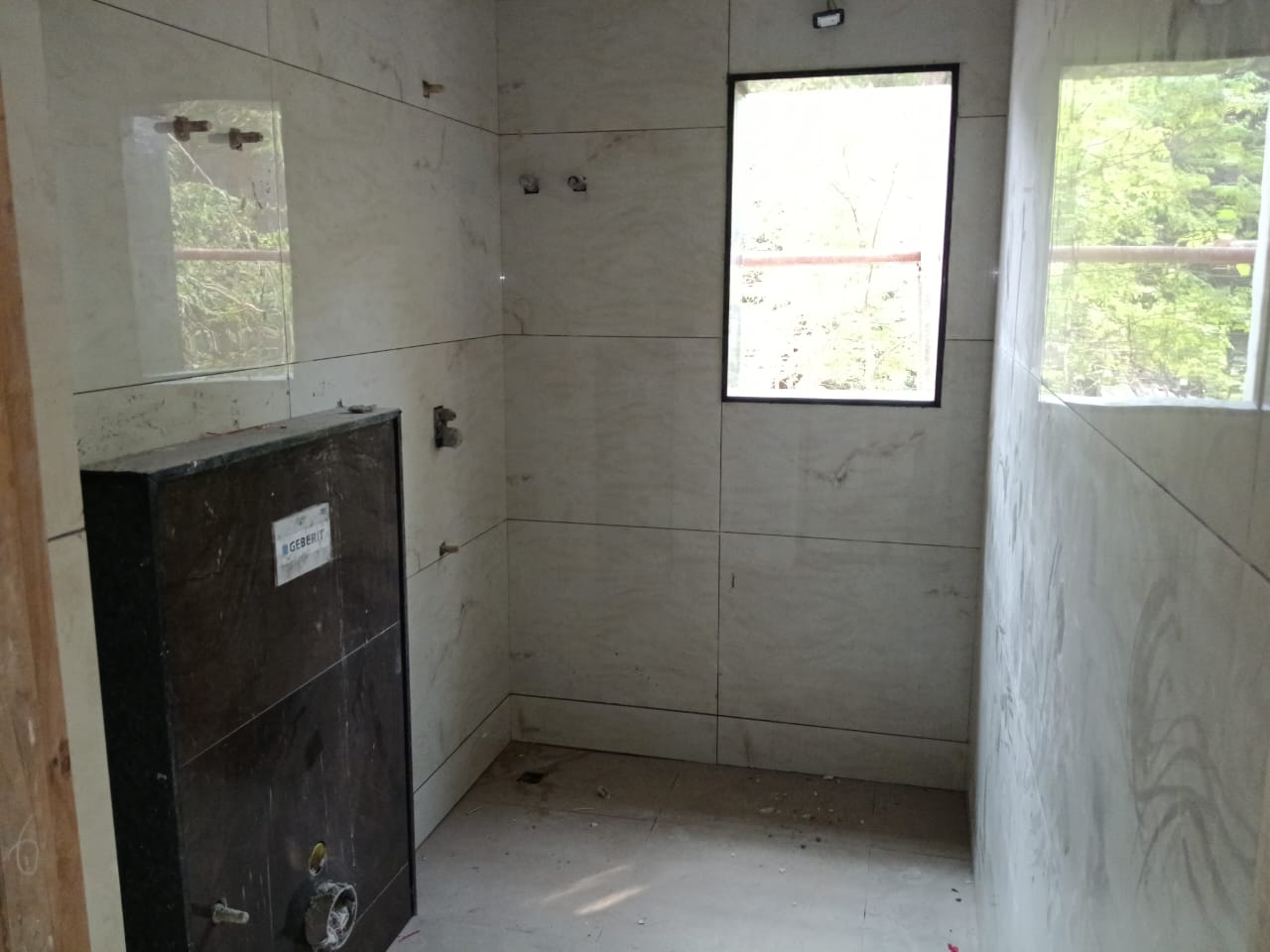

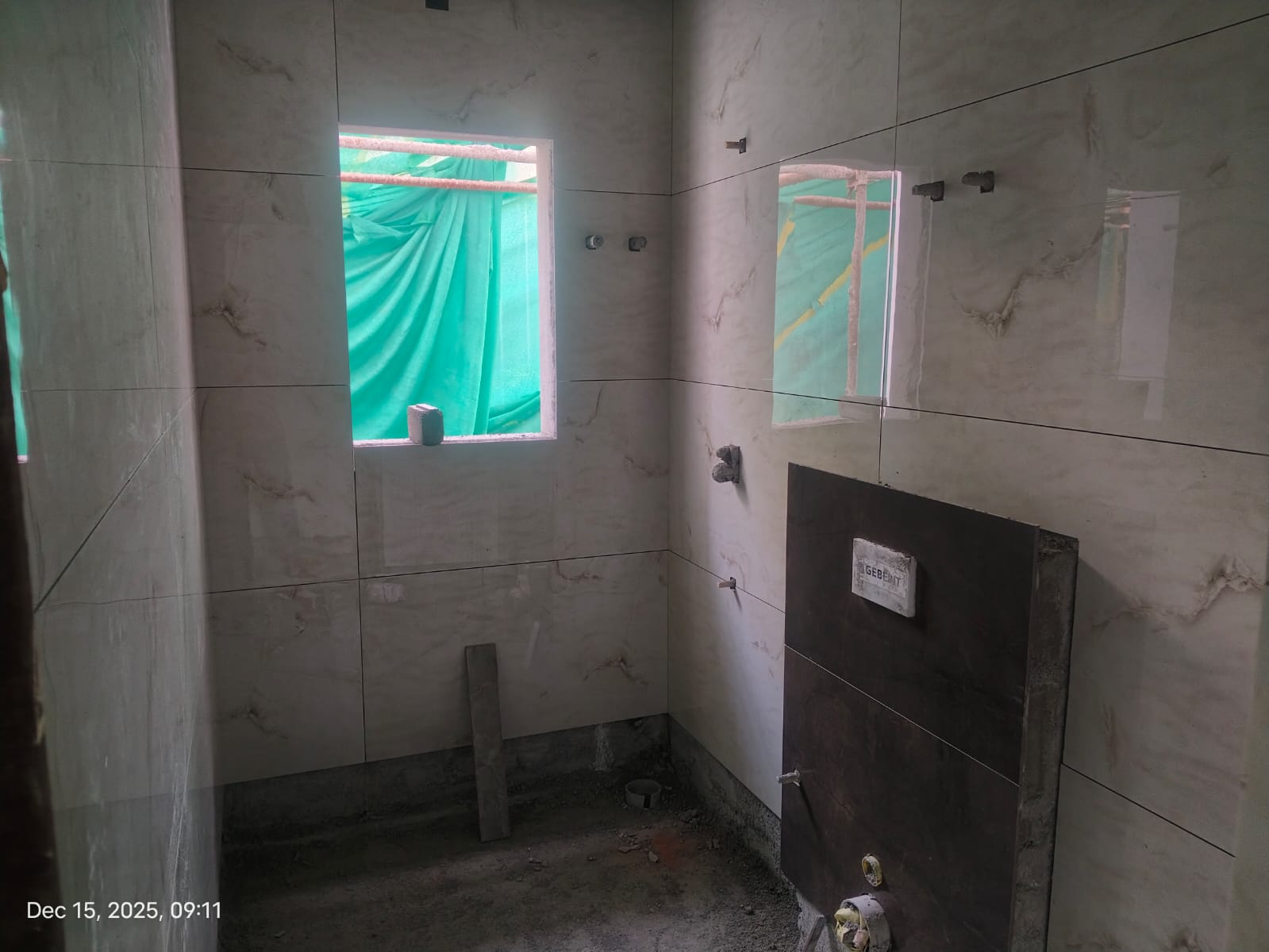

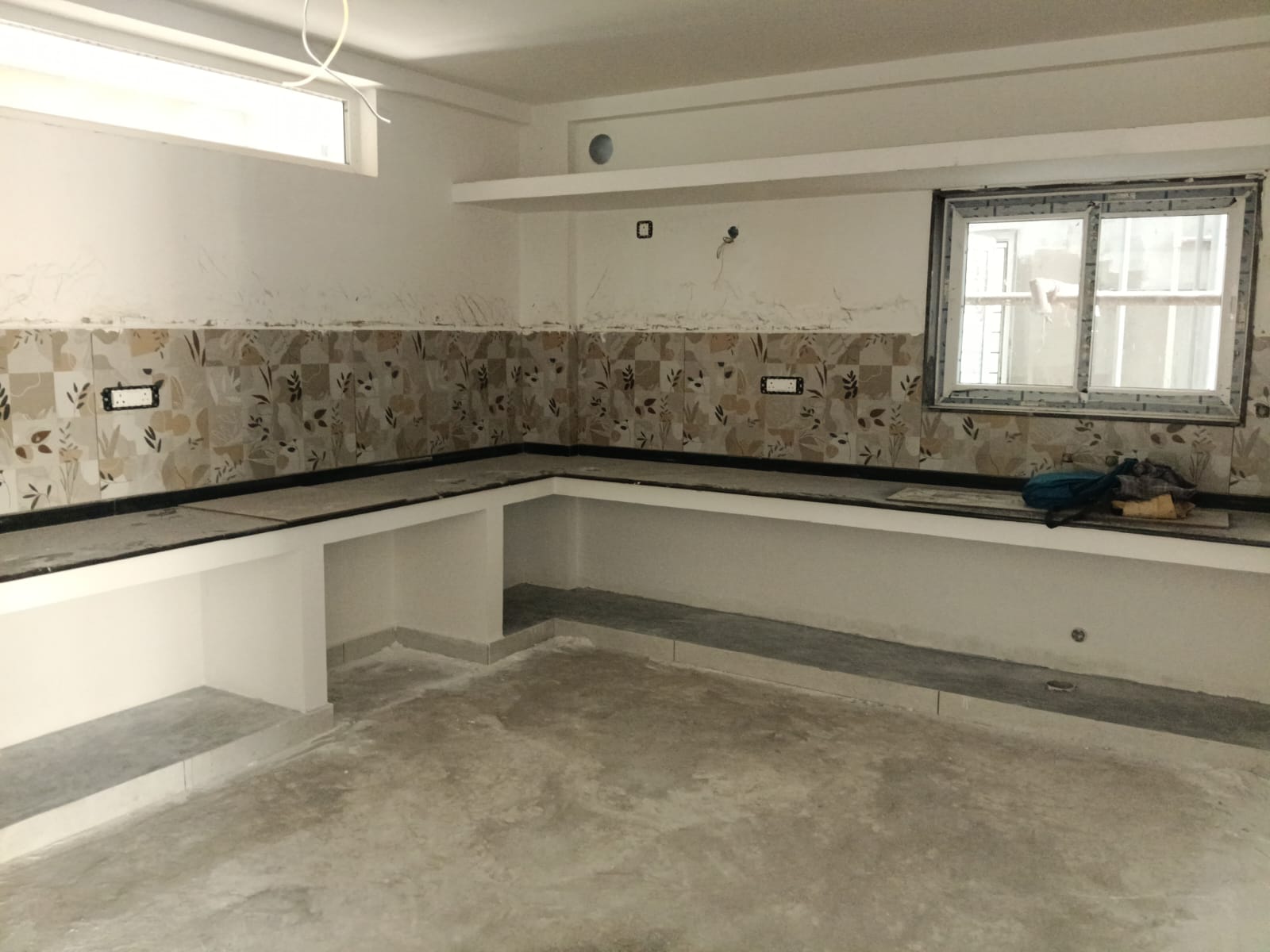

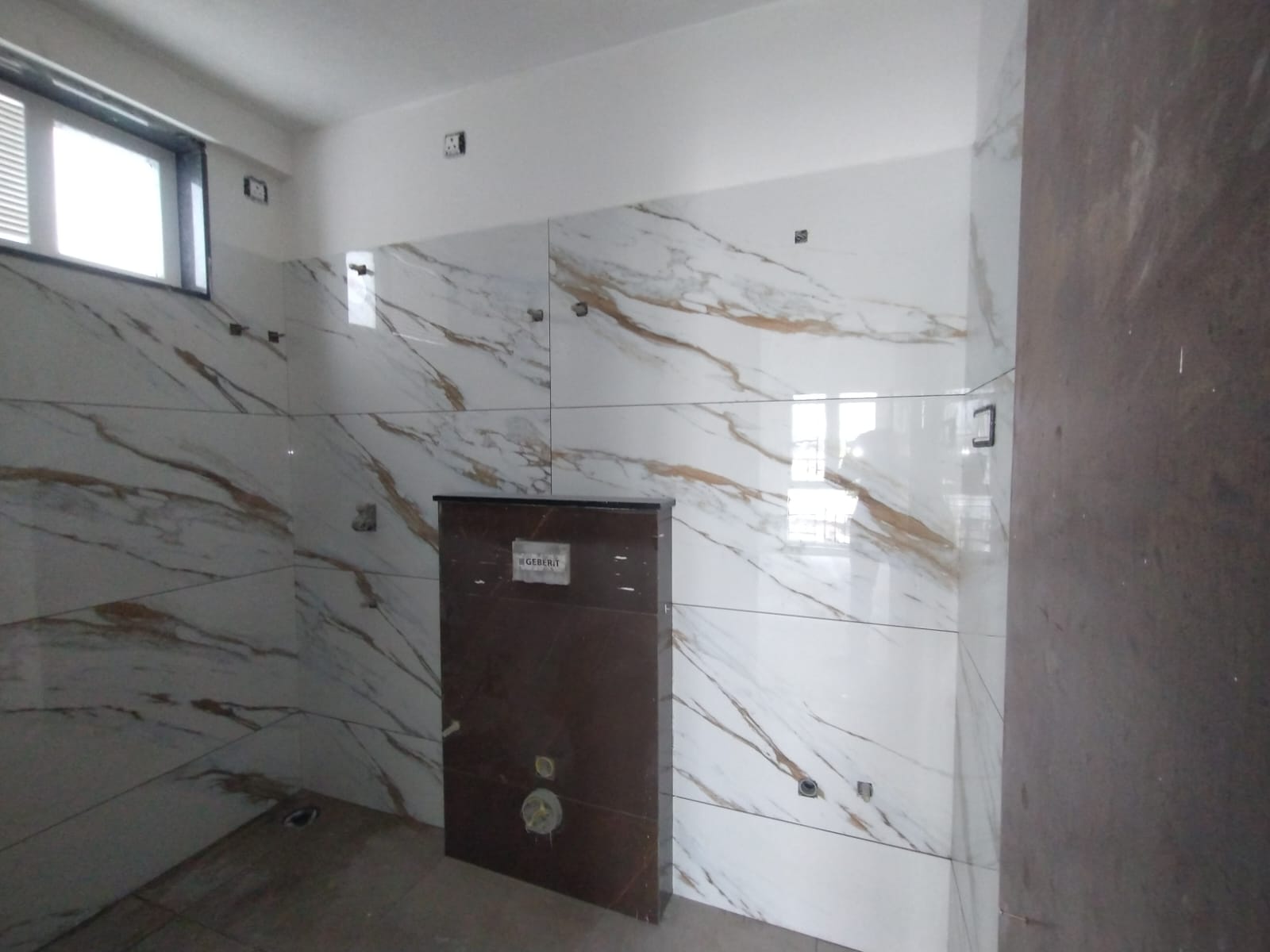

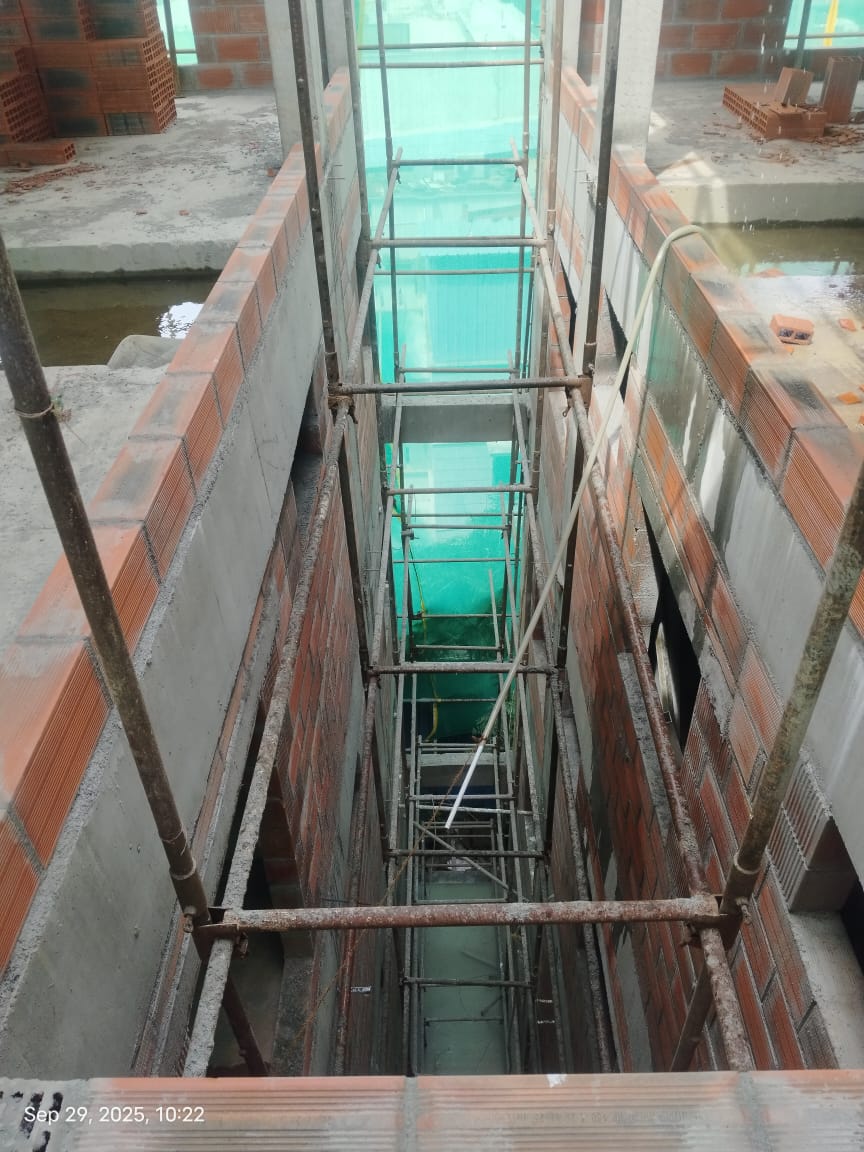

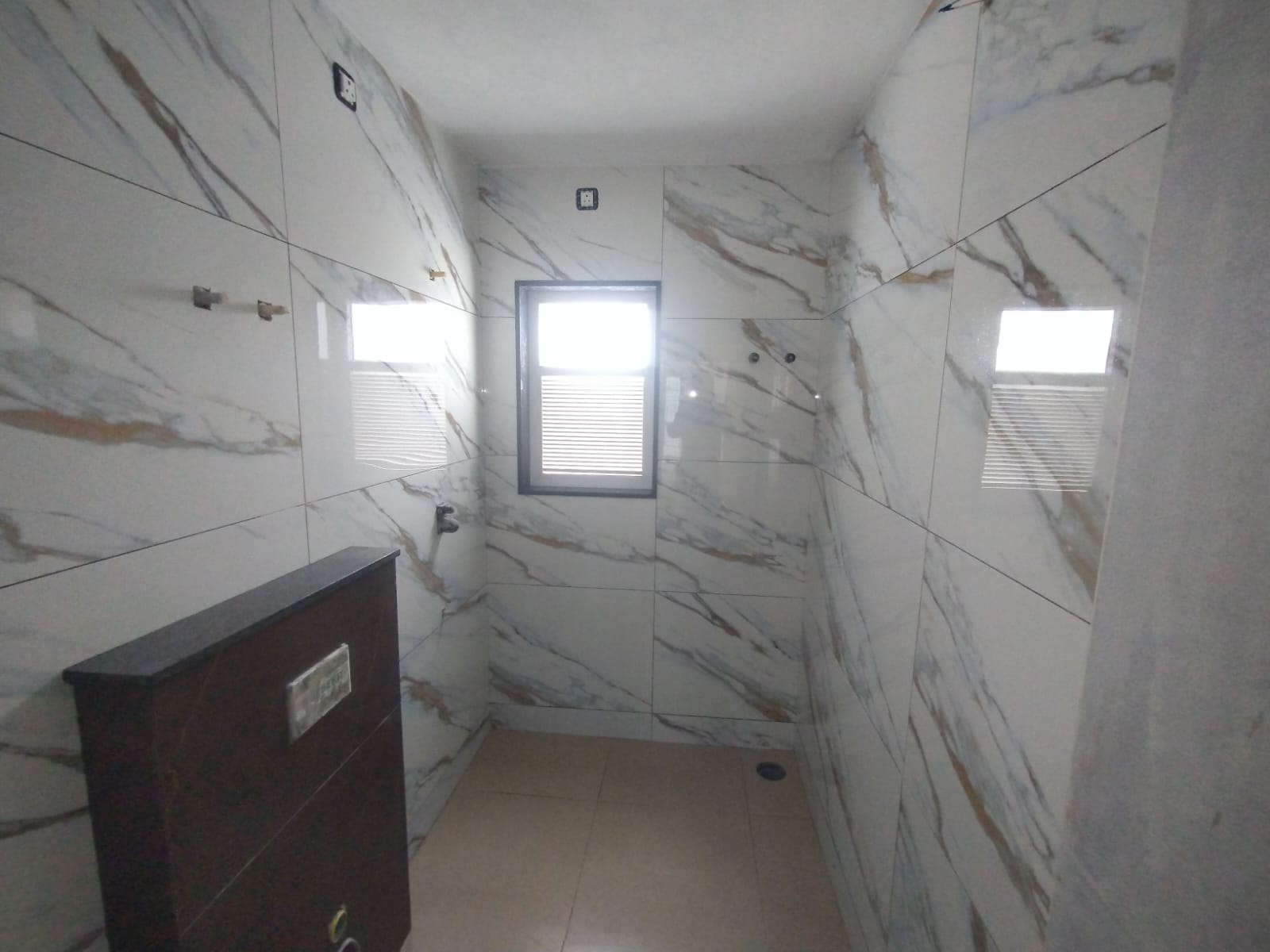

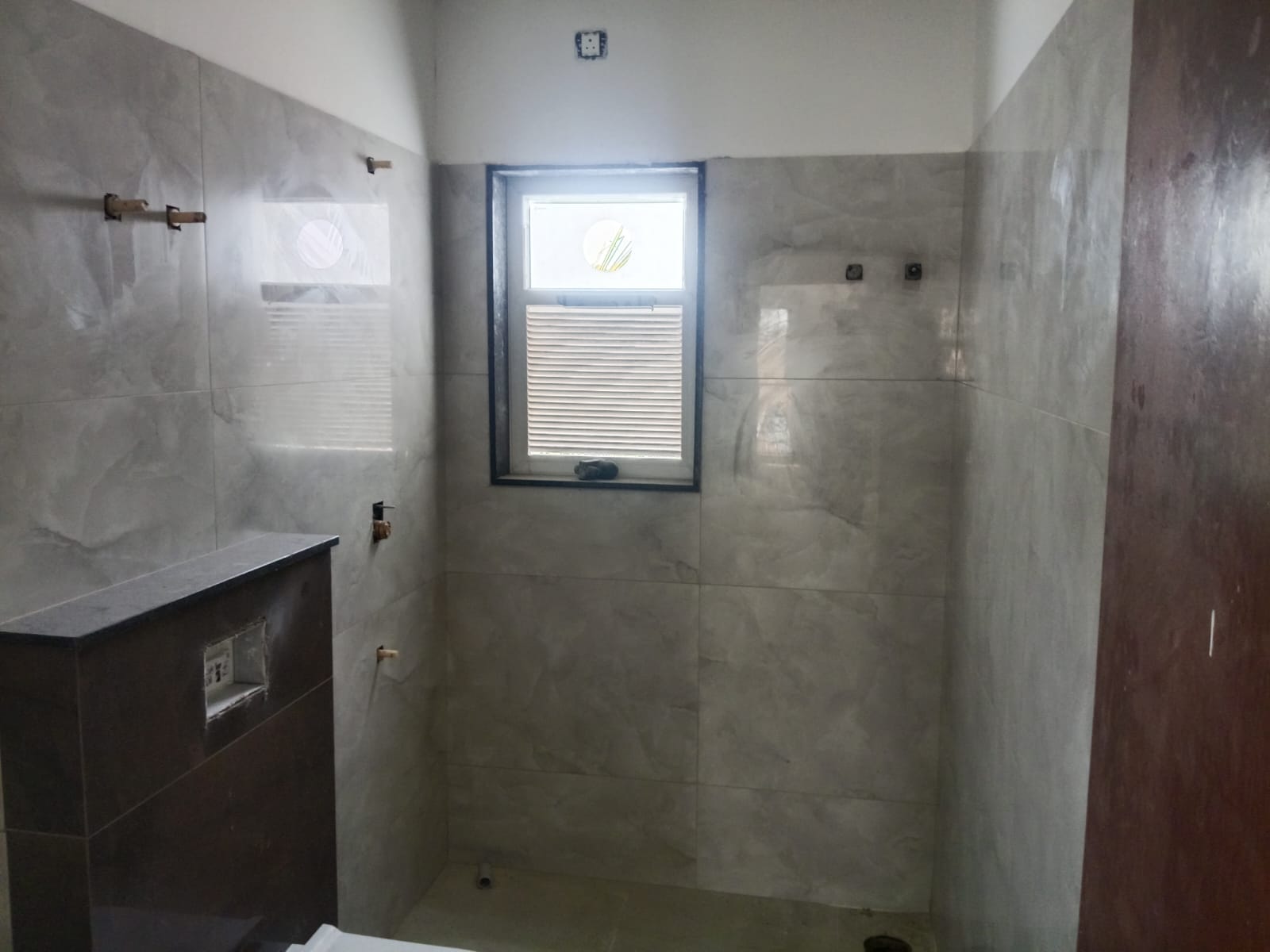

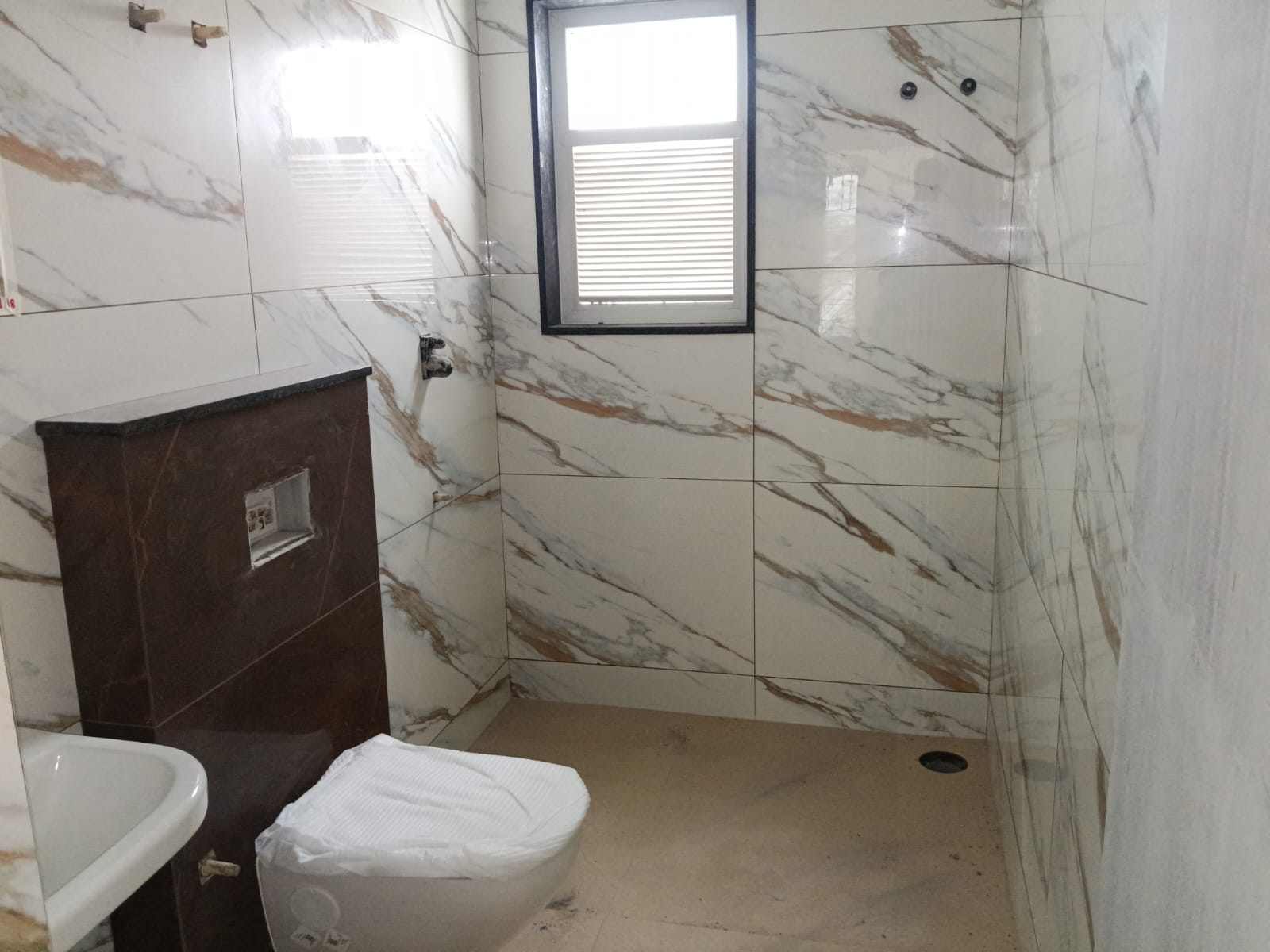

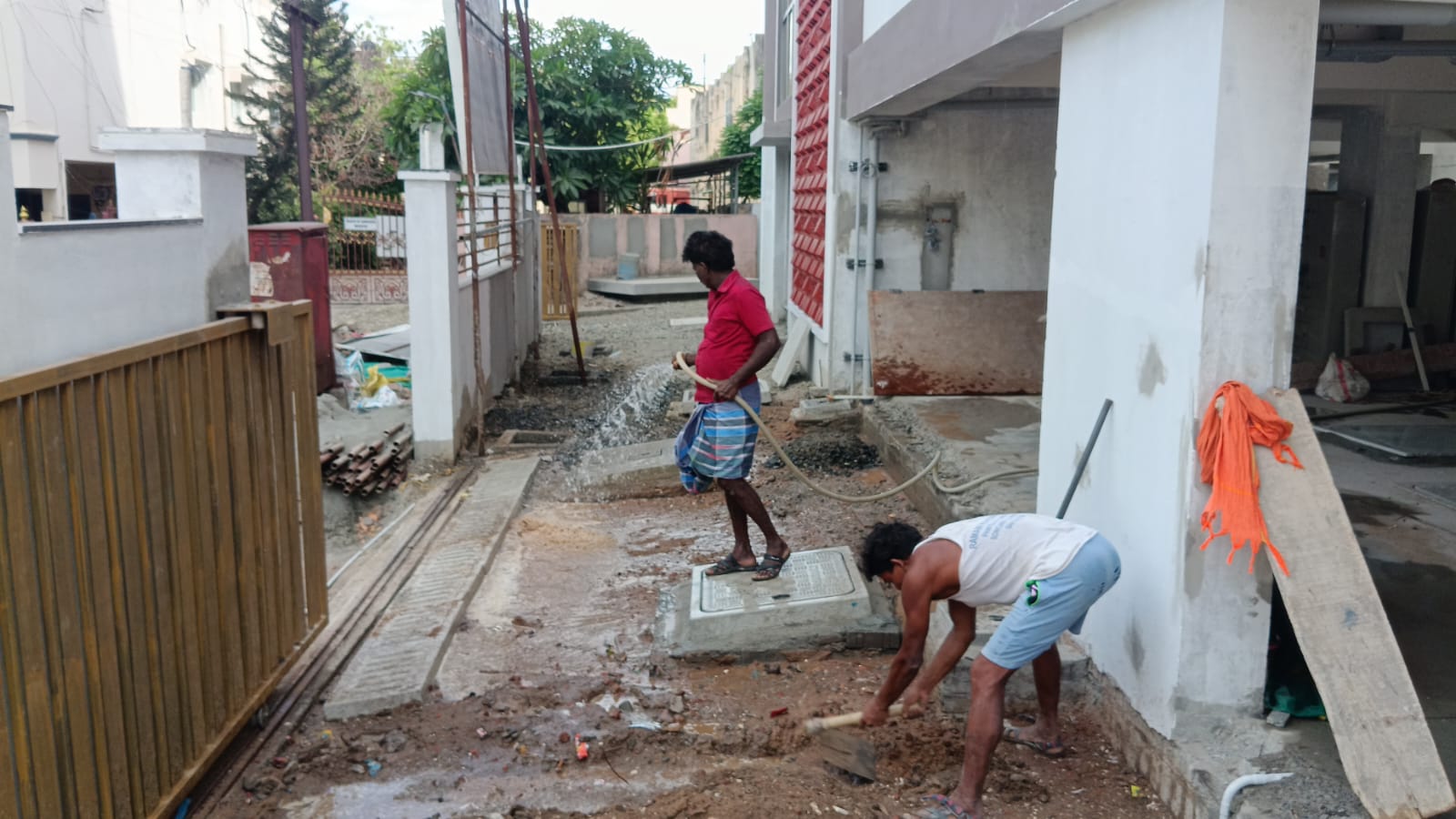

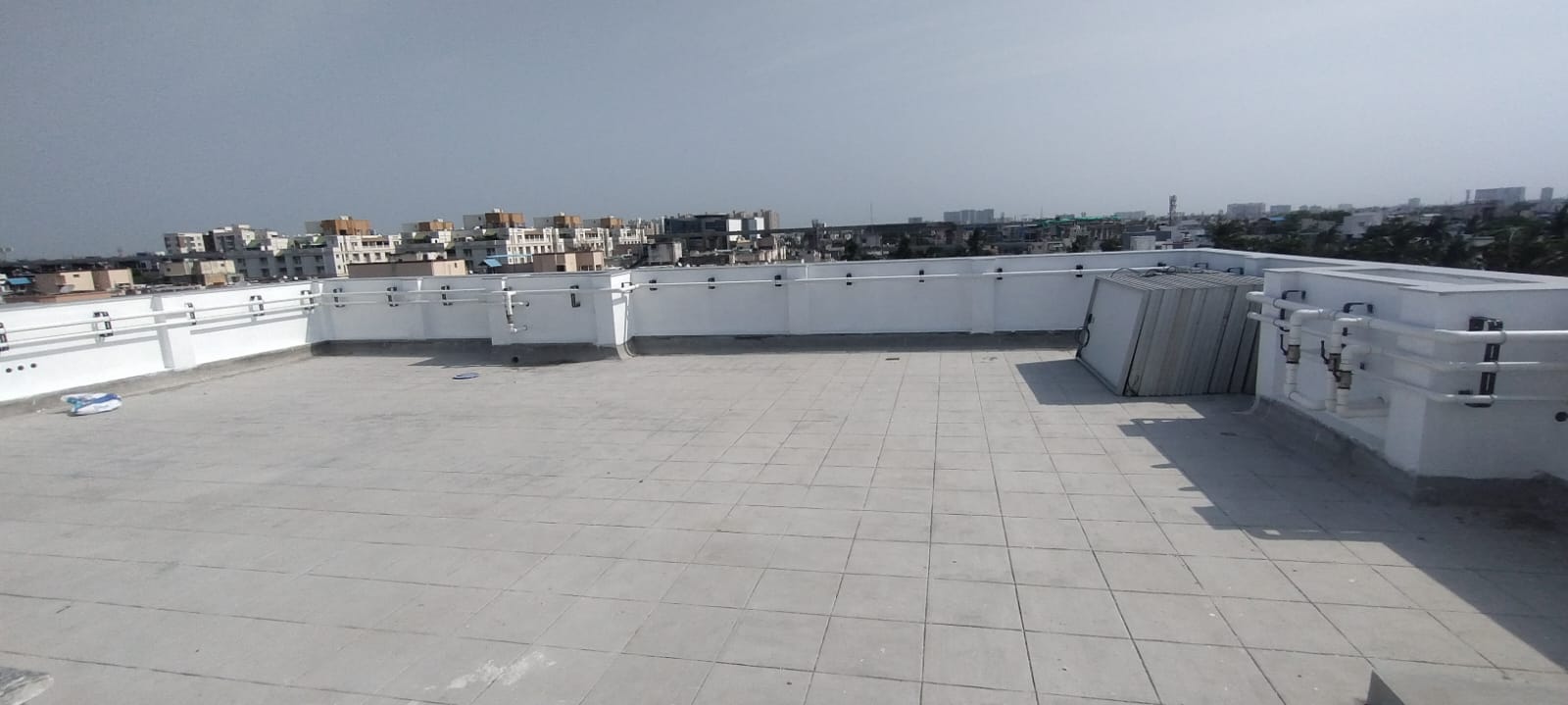

  • 5th floor toilet wall tiles work is in progress. (up to 4th floor completed)

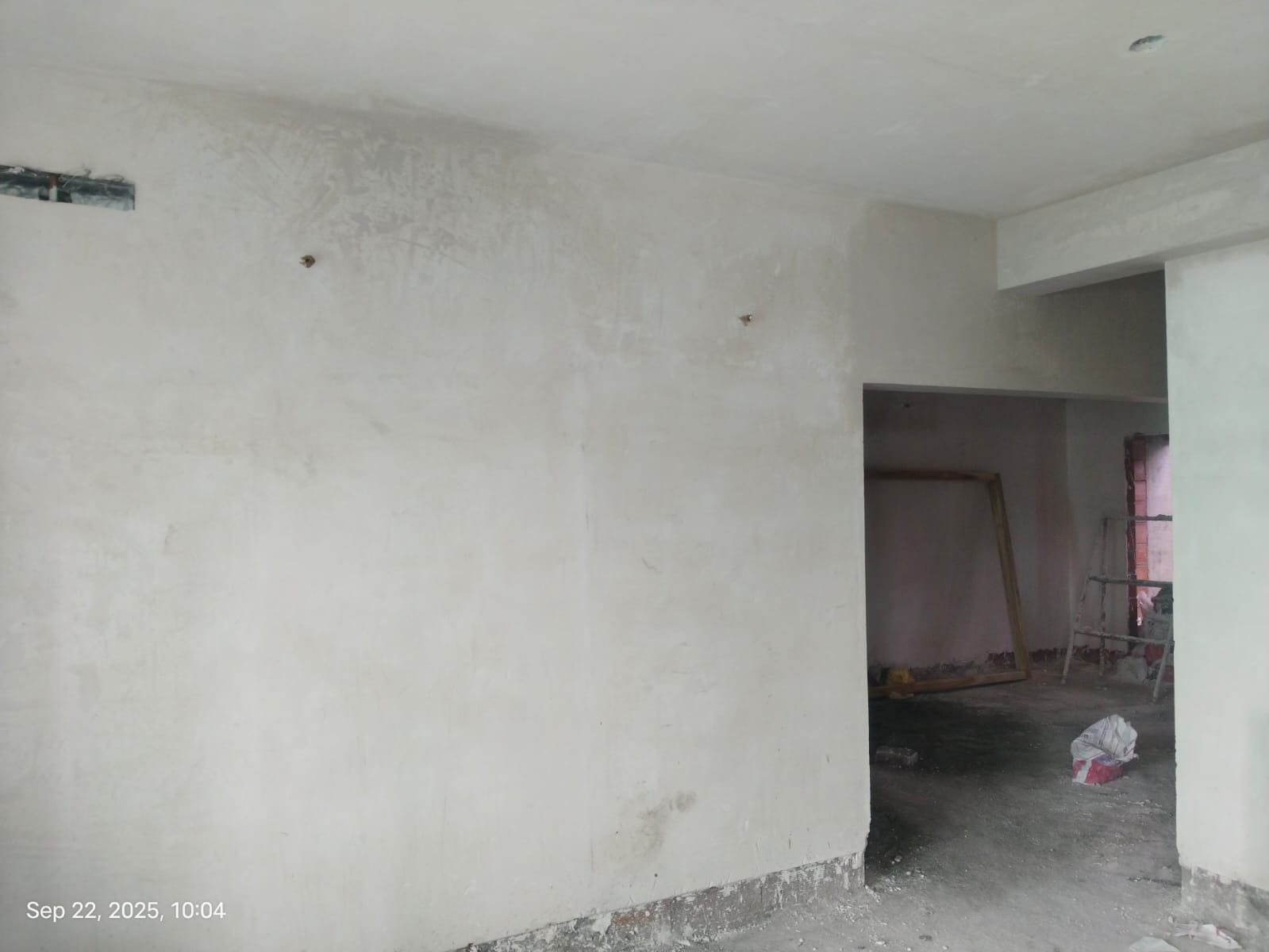

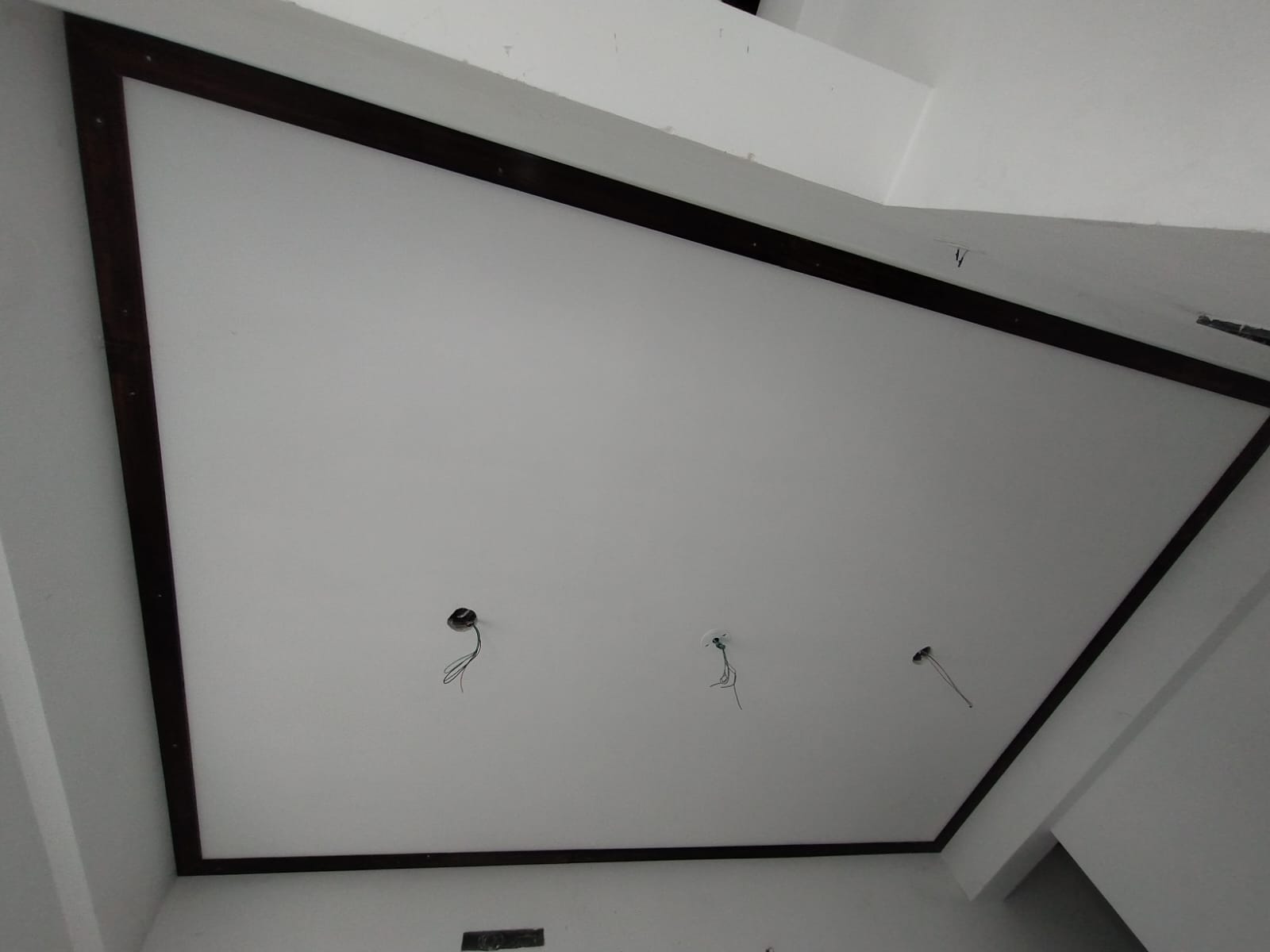

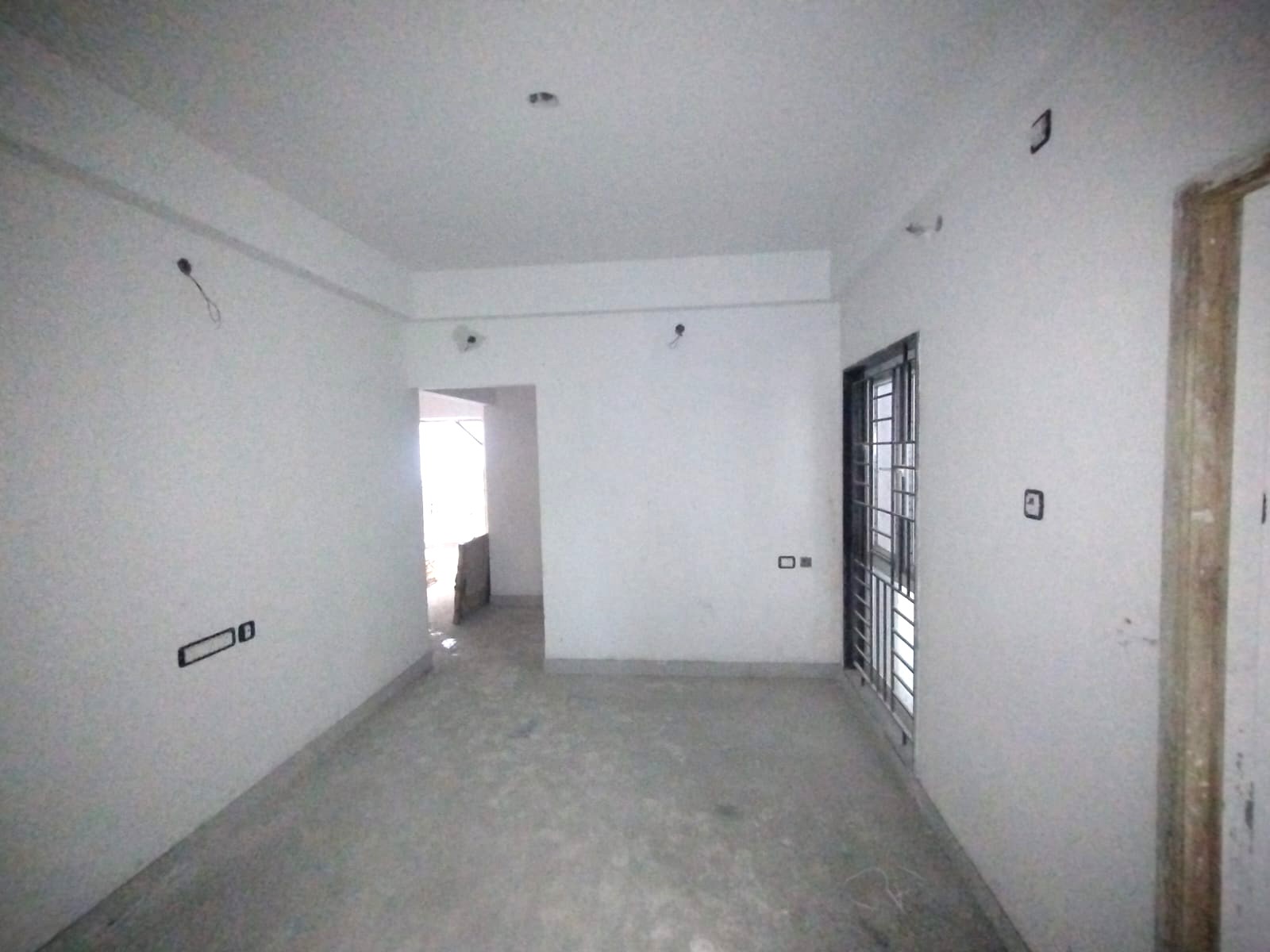

  • Inner primer work is in progress. (Upto 4th floor completed)

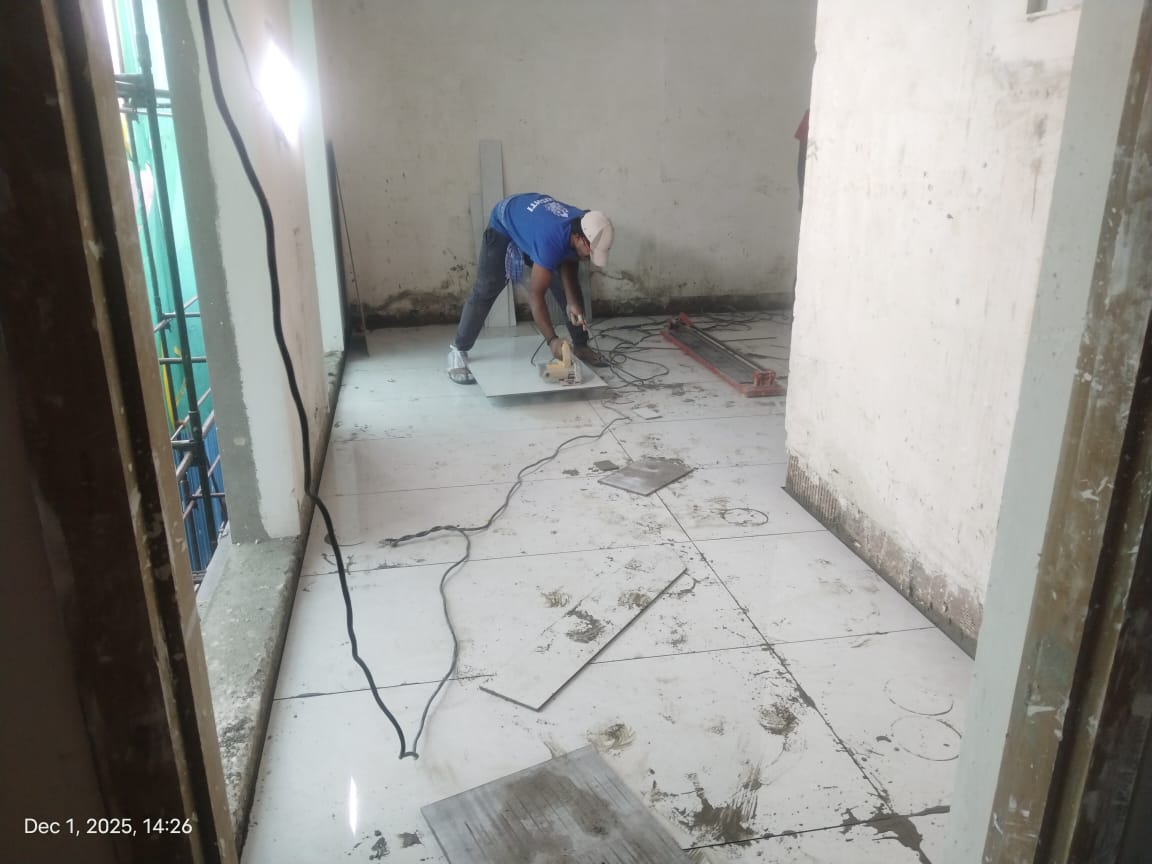

  • Main flooring tiles work is in progress. (Up to 4th floor completed, 5th floor 60% completed).

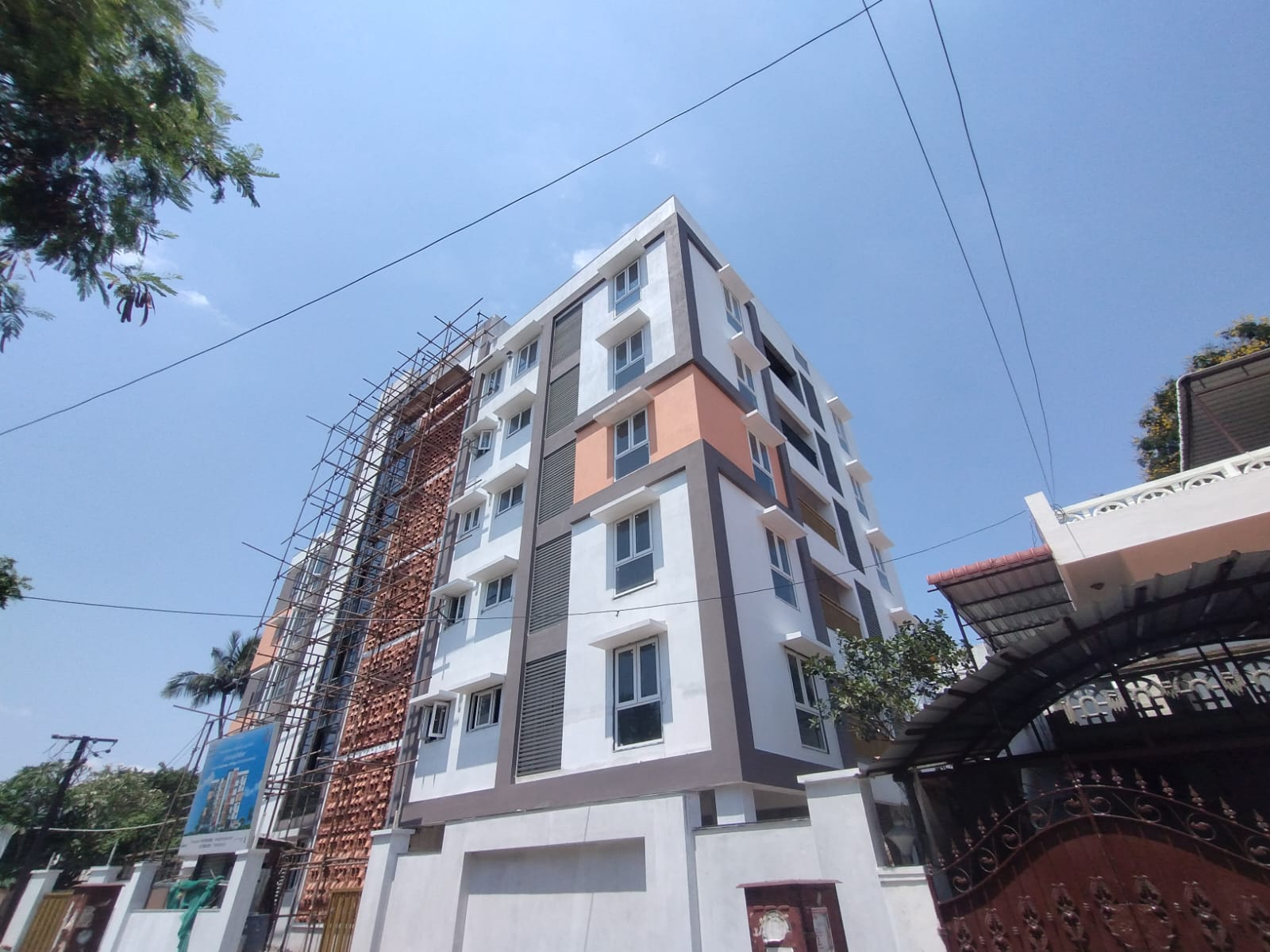

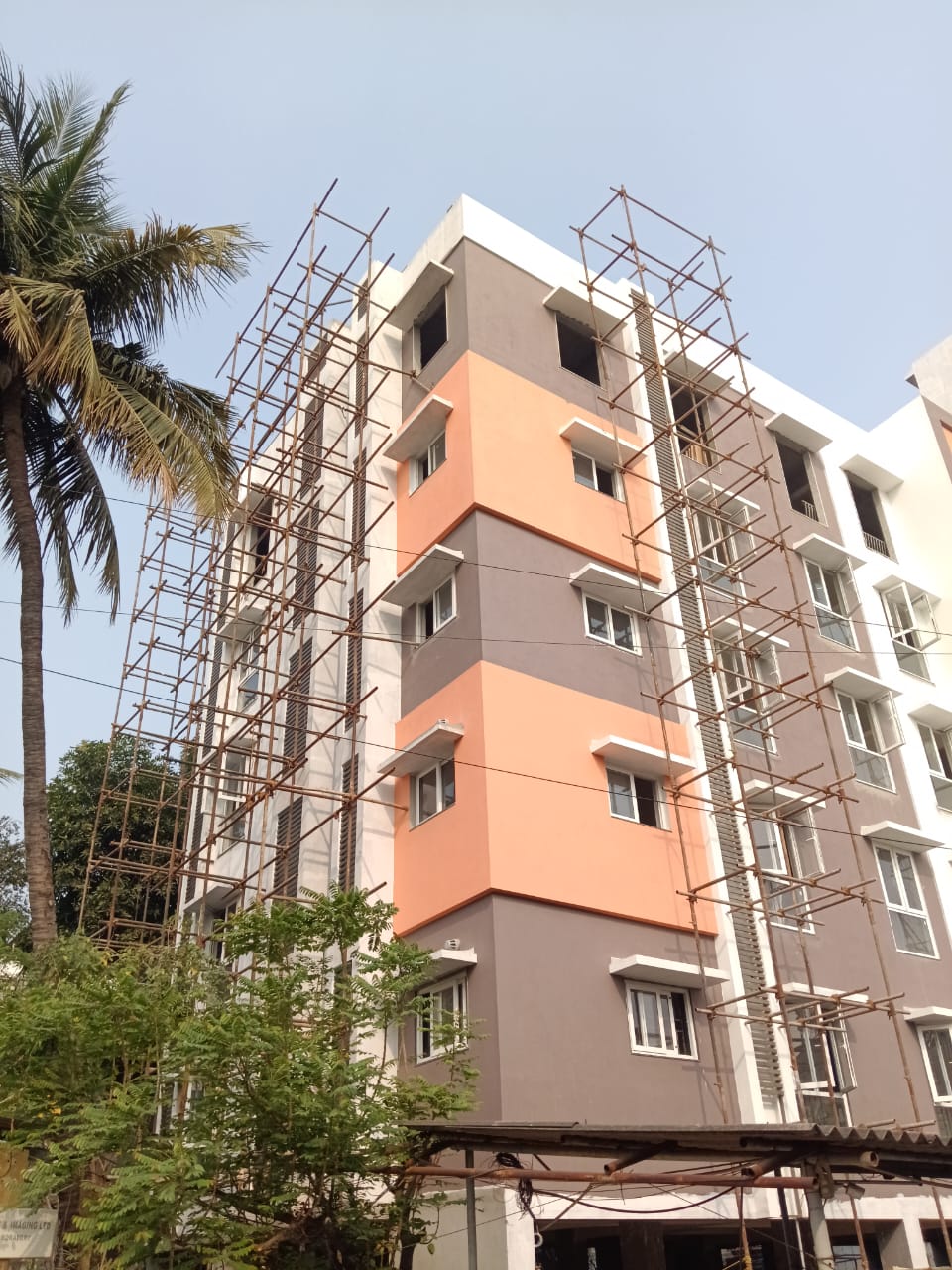

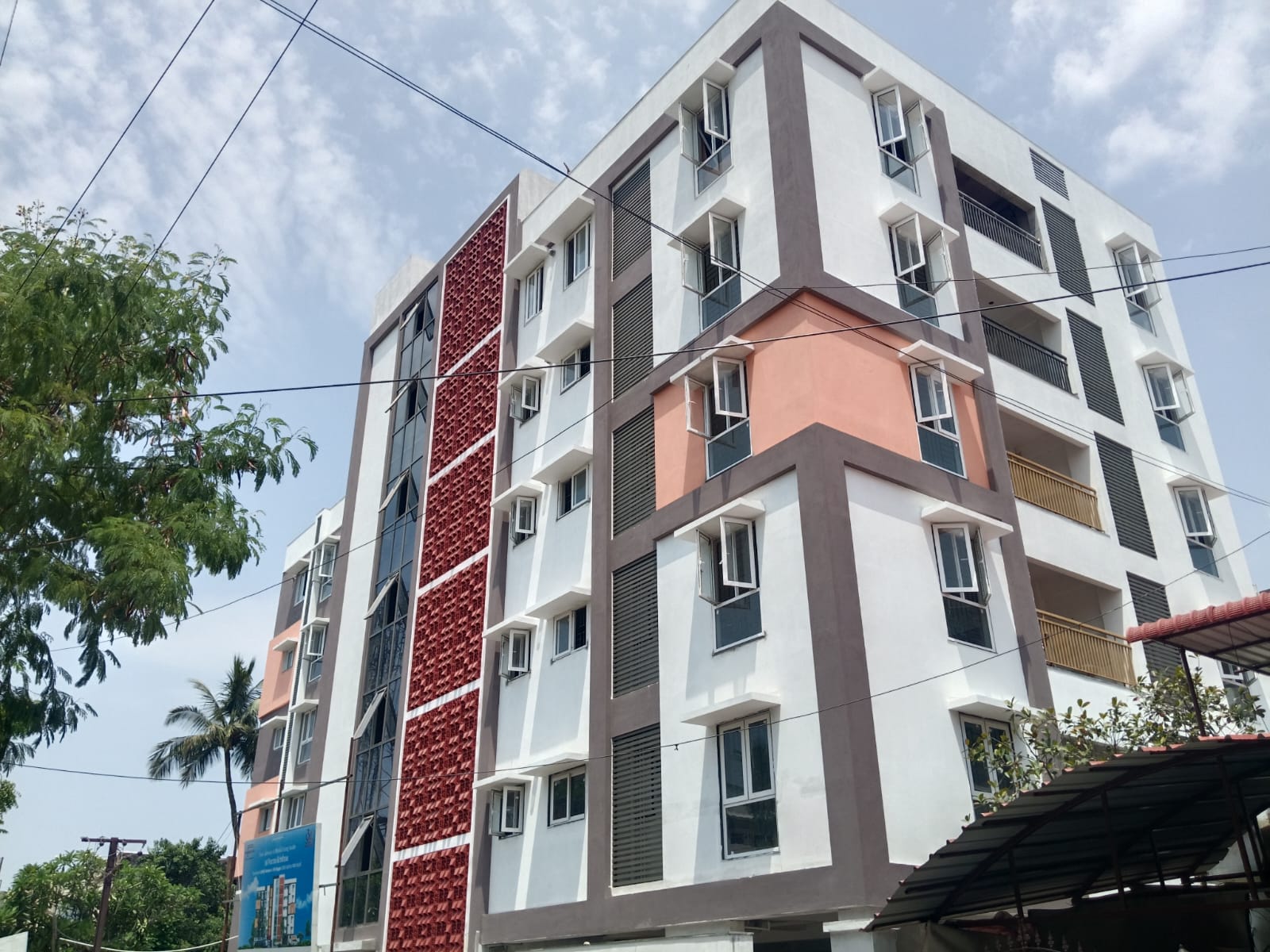

  • External 1st coat painting work is completed.

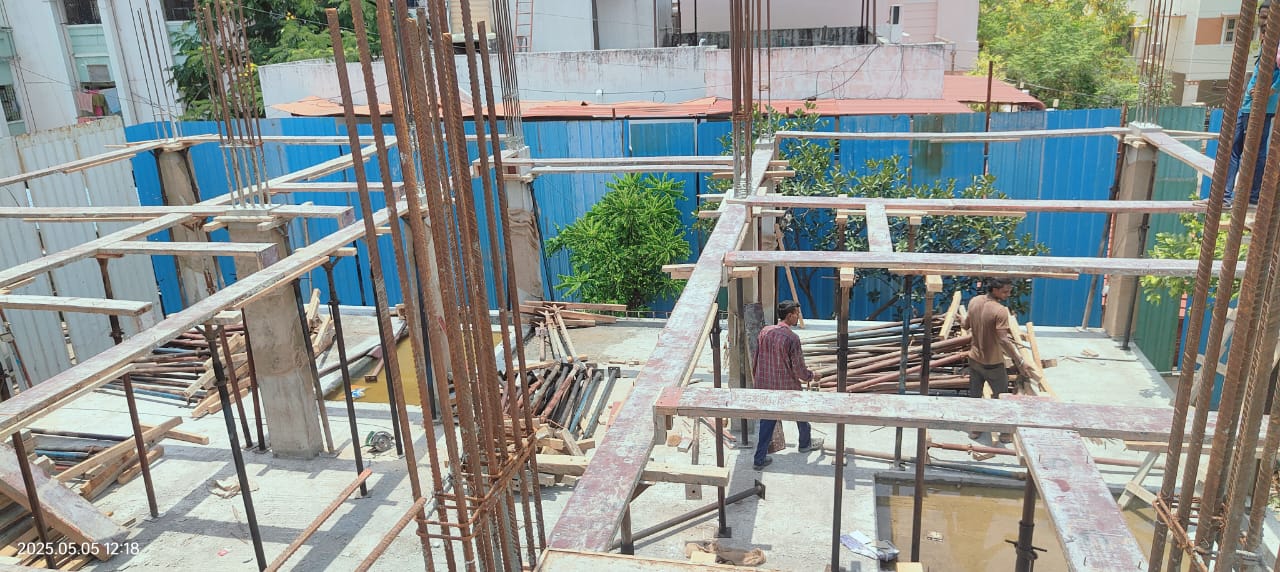

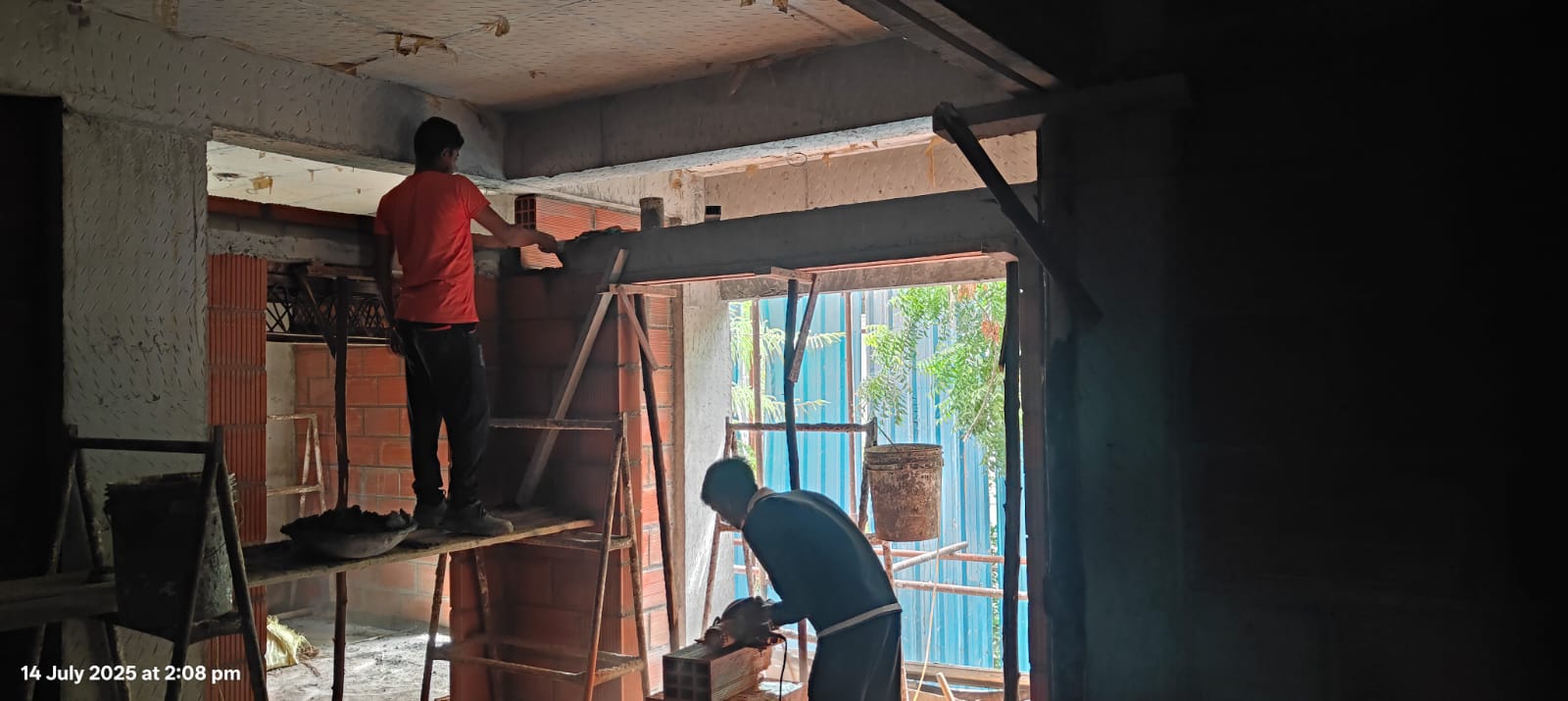

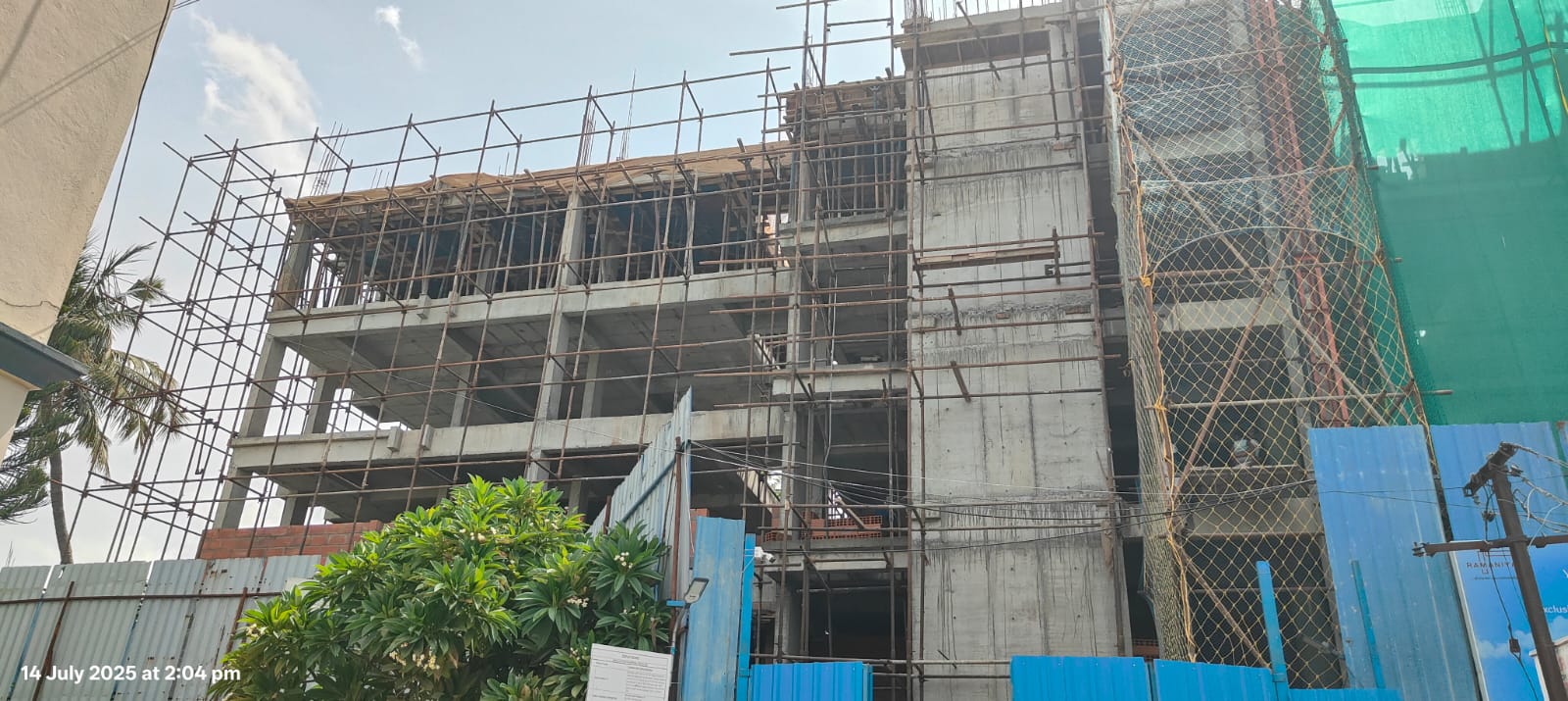

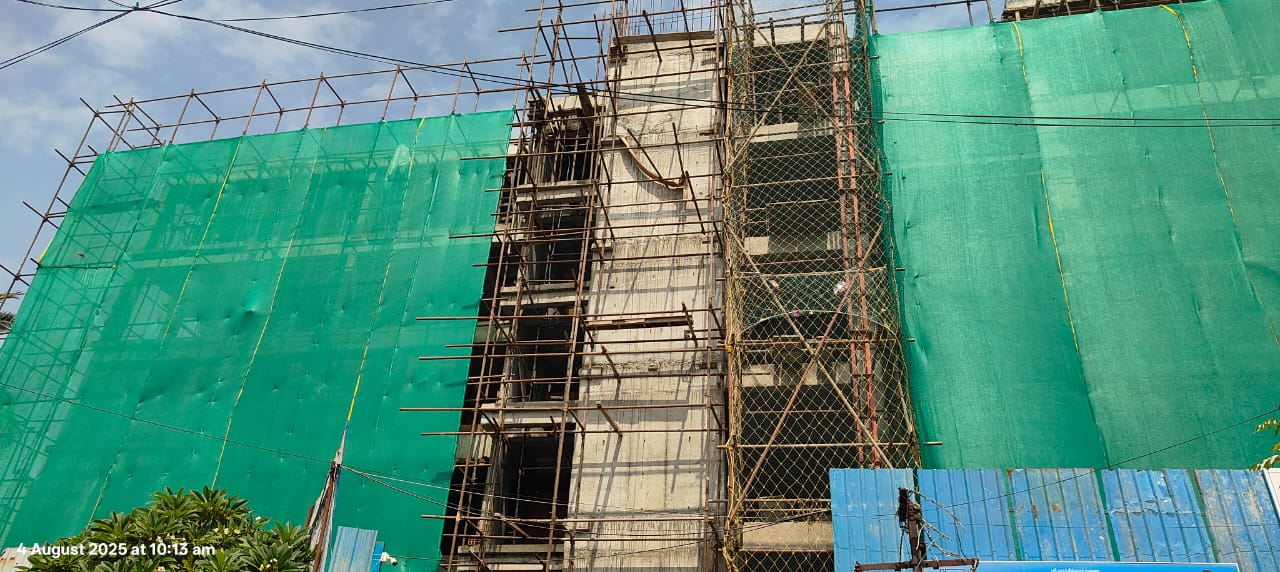

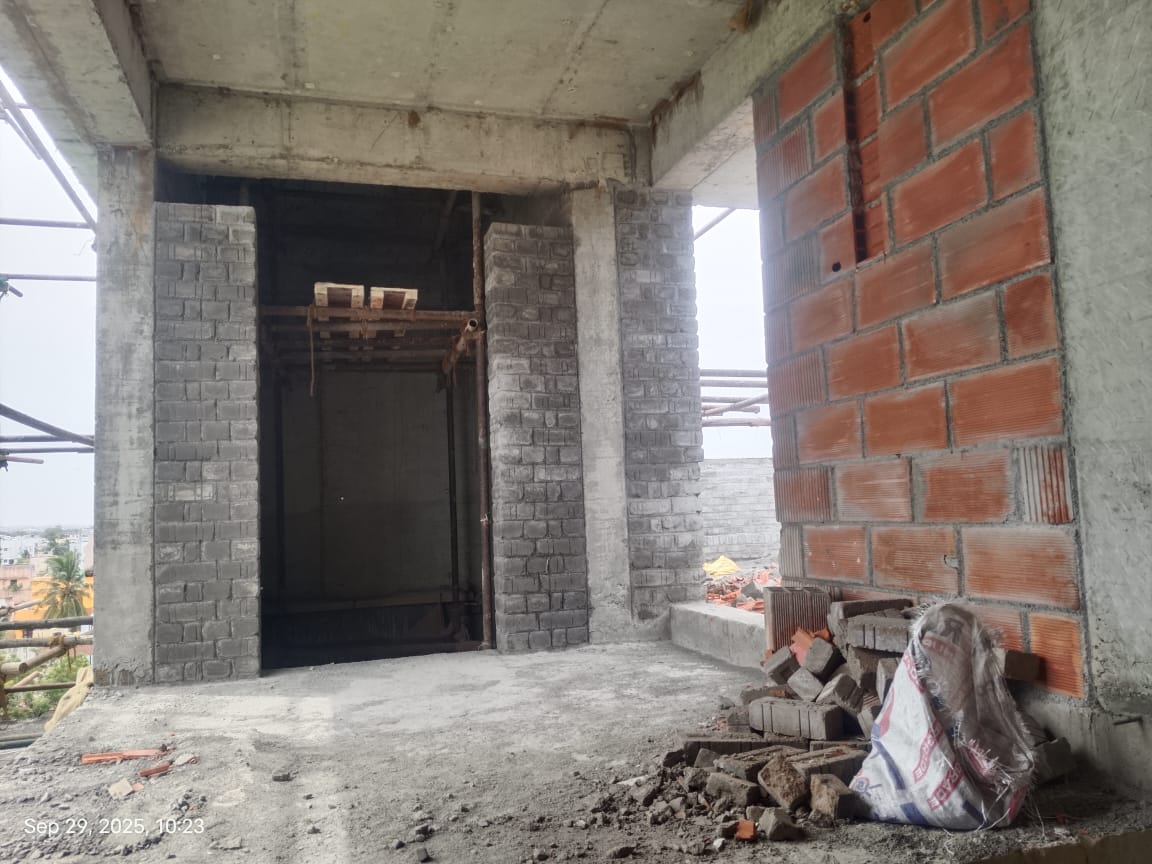

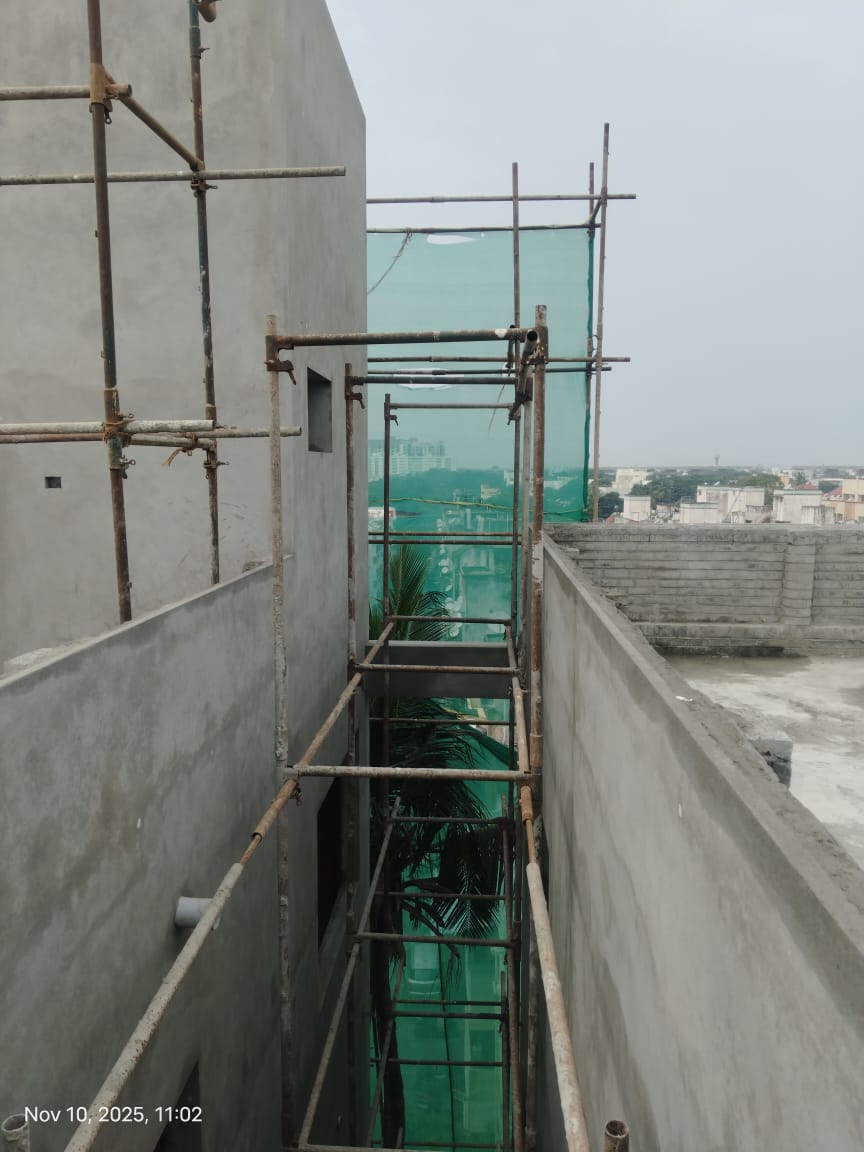

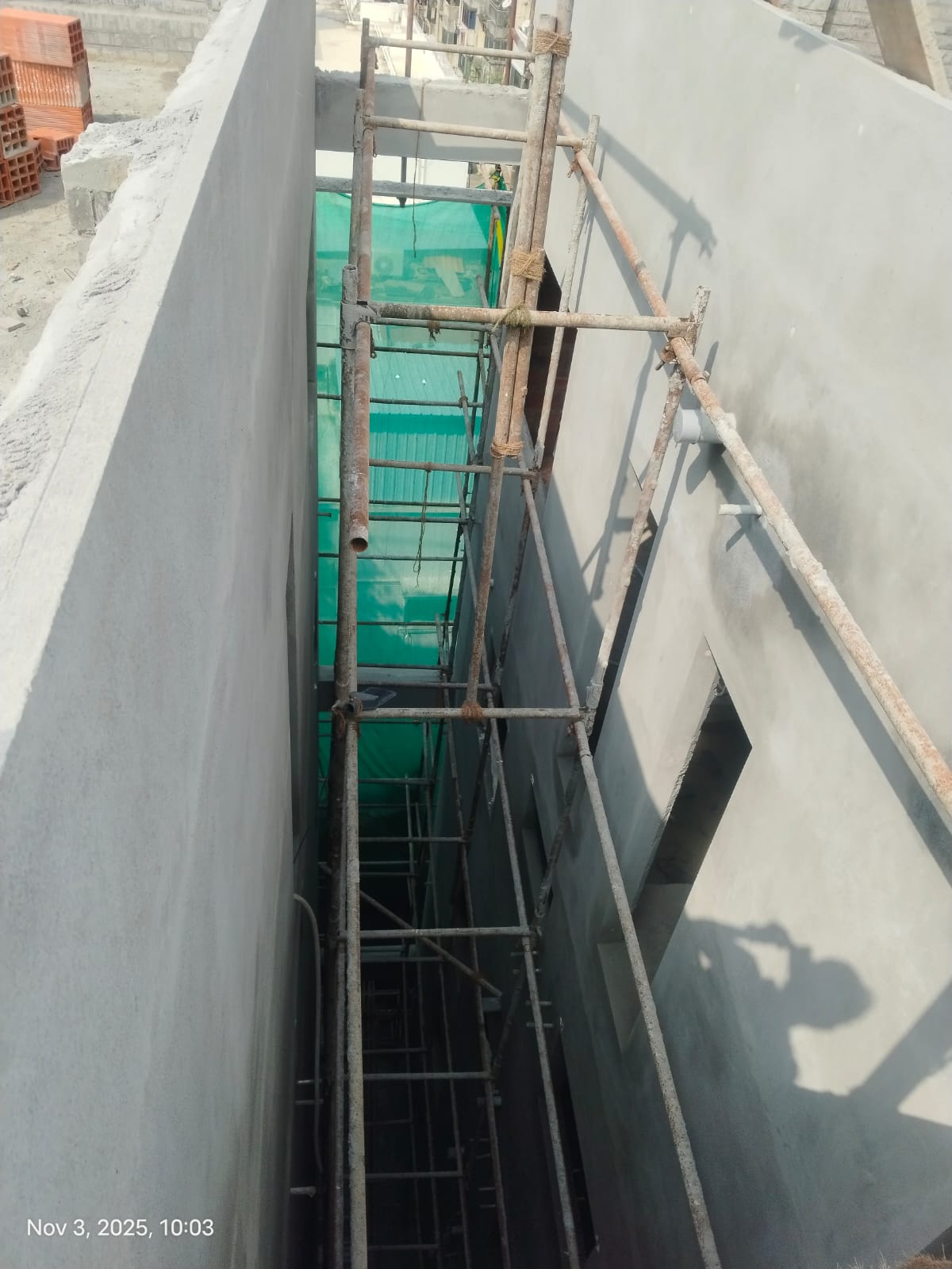

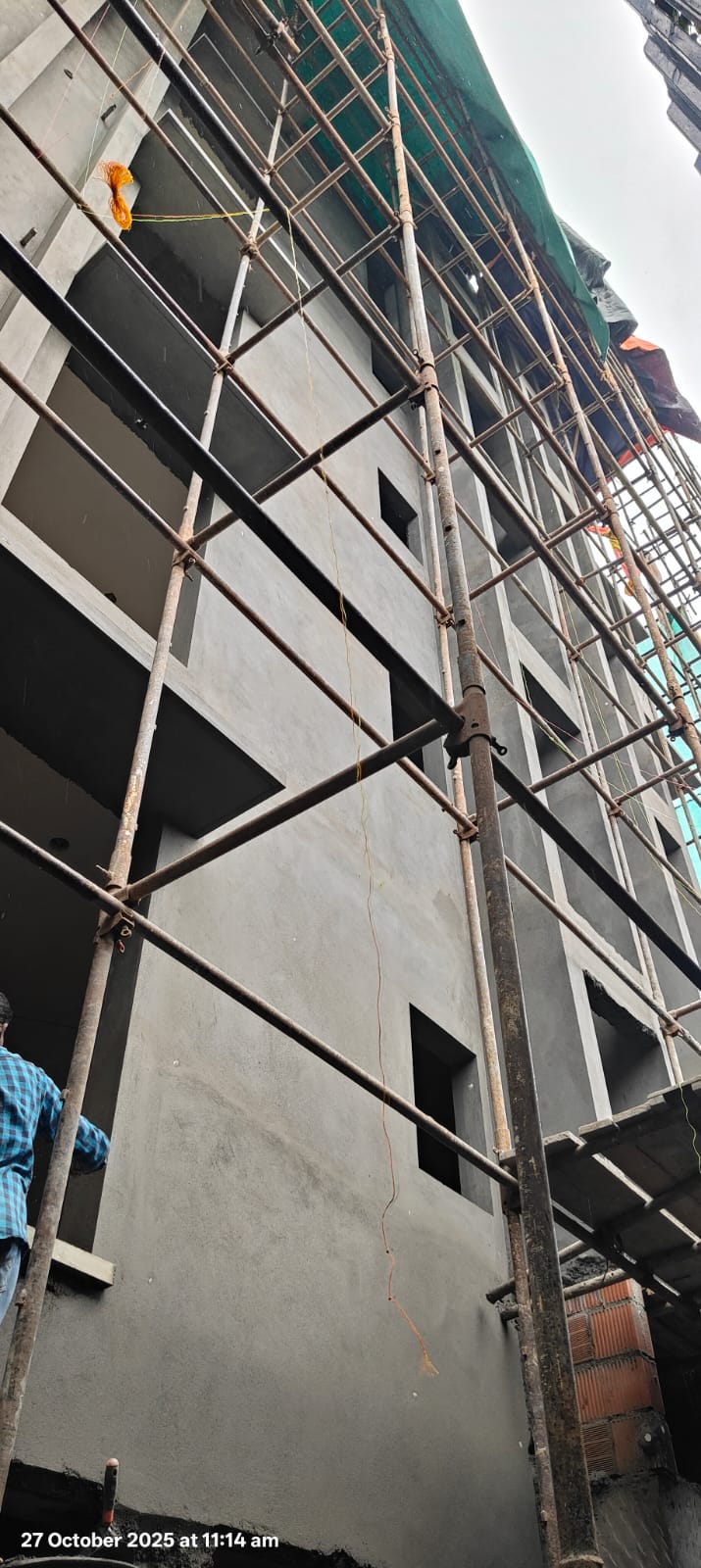

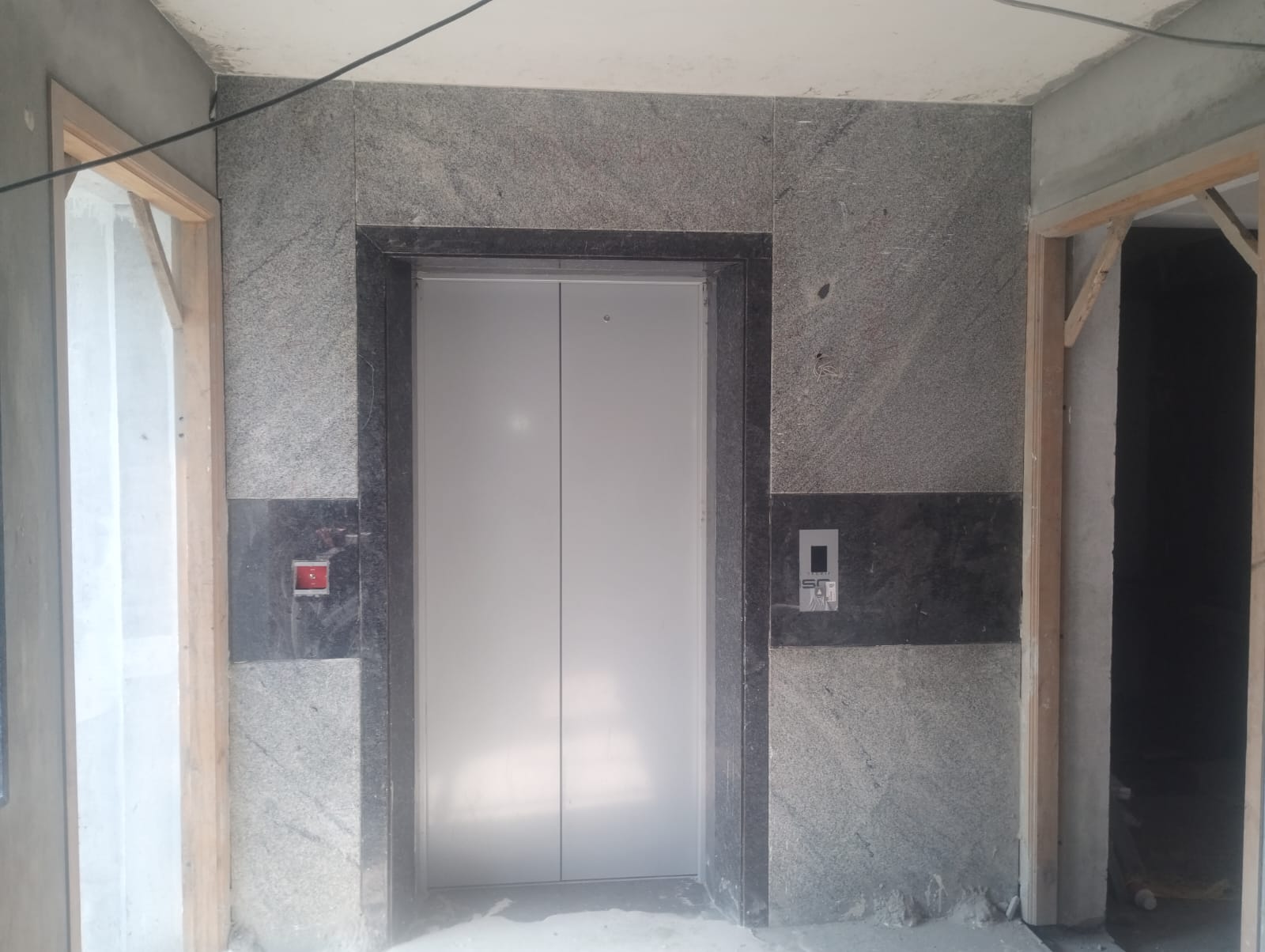

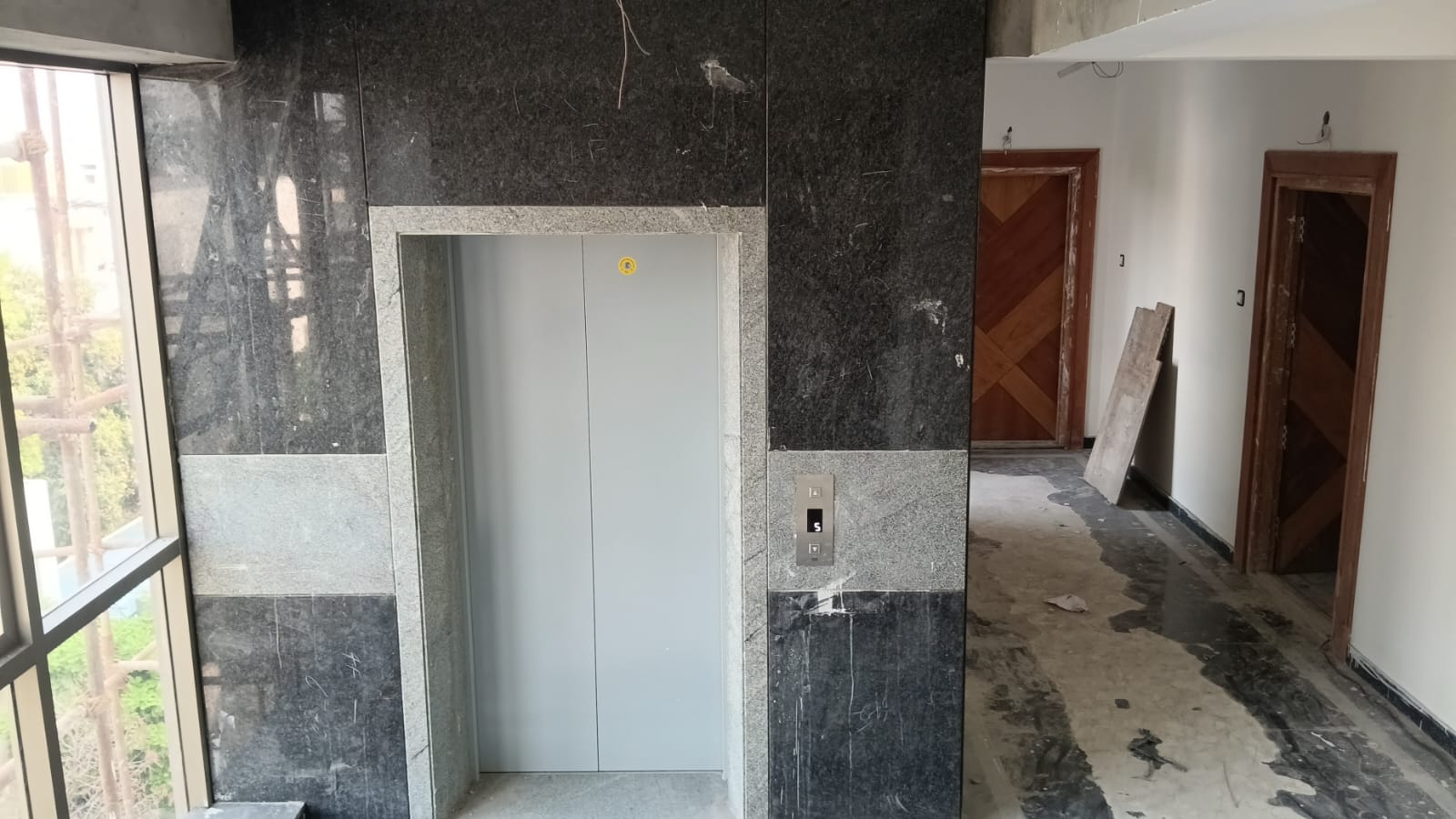

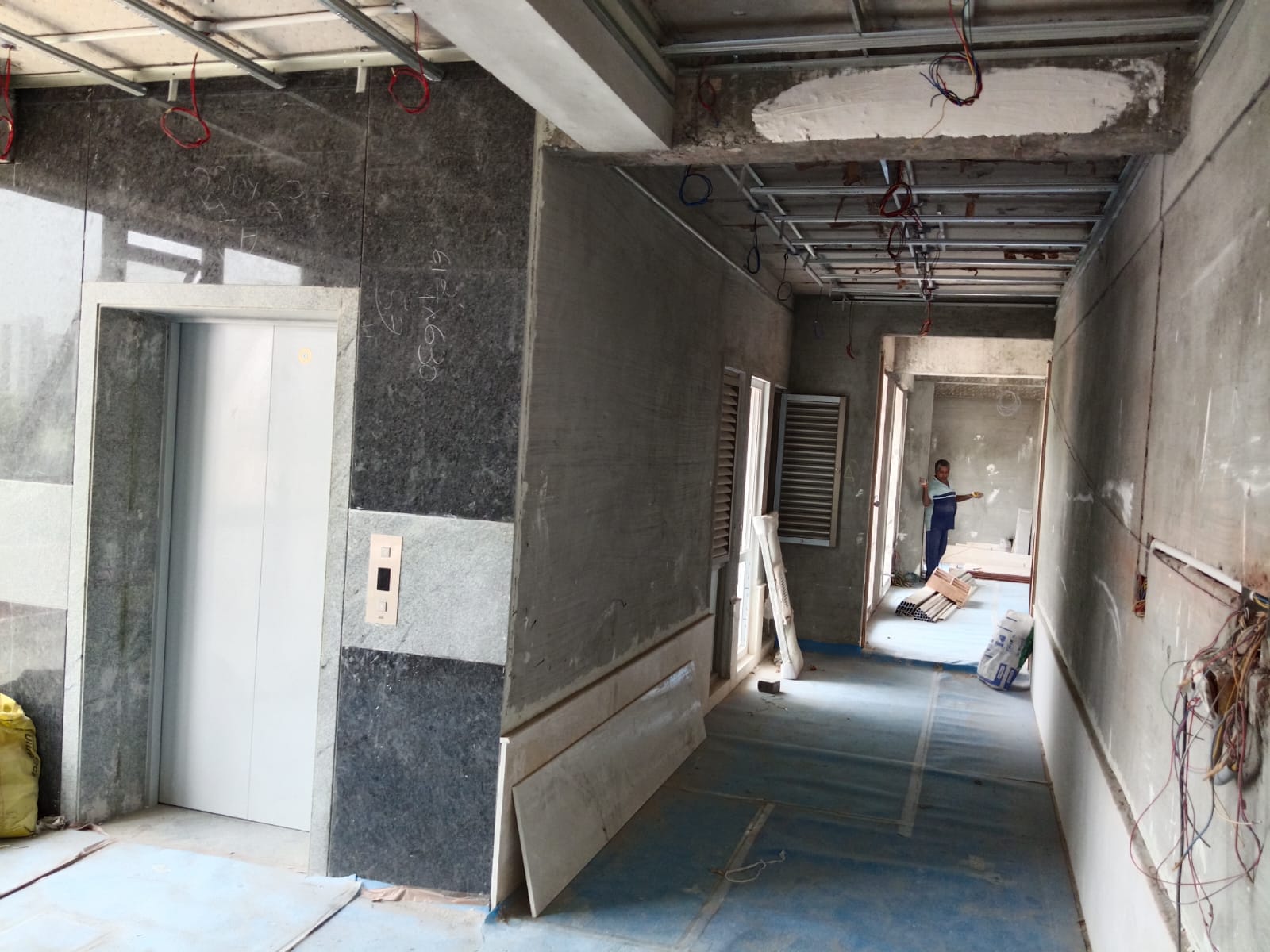

  • Lift erection work is in progress.(90% completed)
  • All floors lift wall cladding work is completed.

  • Elevation terracottajalli work is in progress.(30% completed)

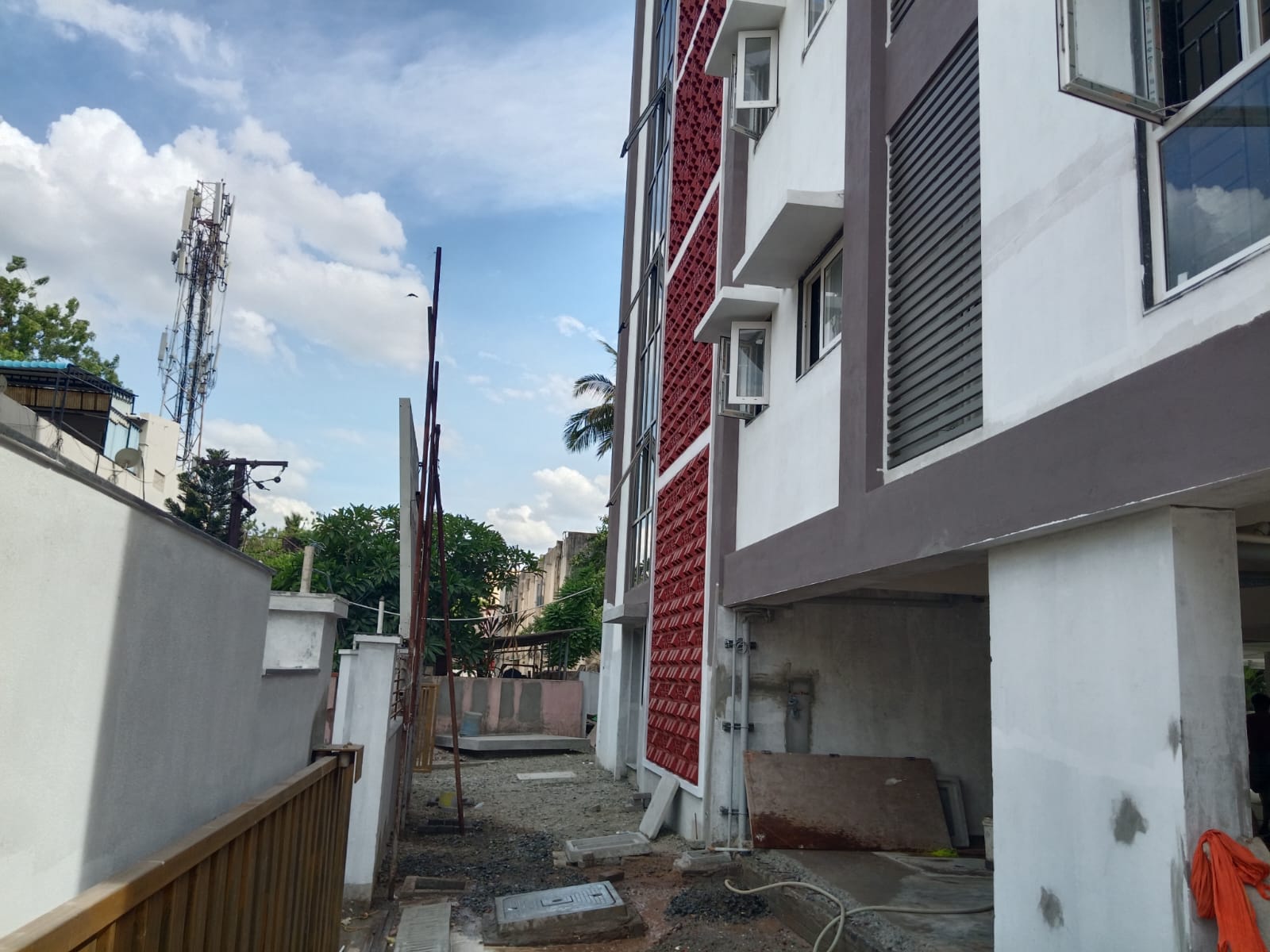

  • External chamber work is in progress.(70% completed)
  • Compound wall work is in progress. (60% completed)

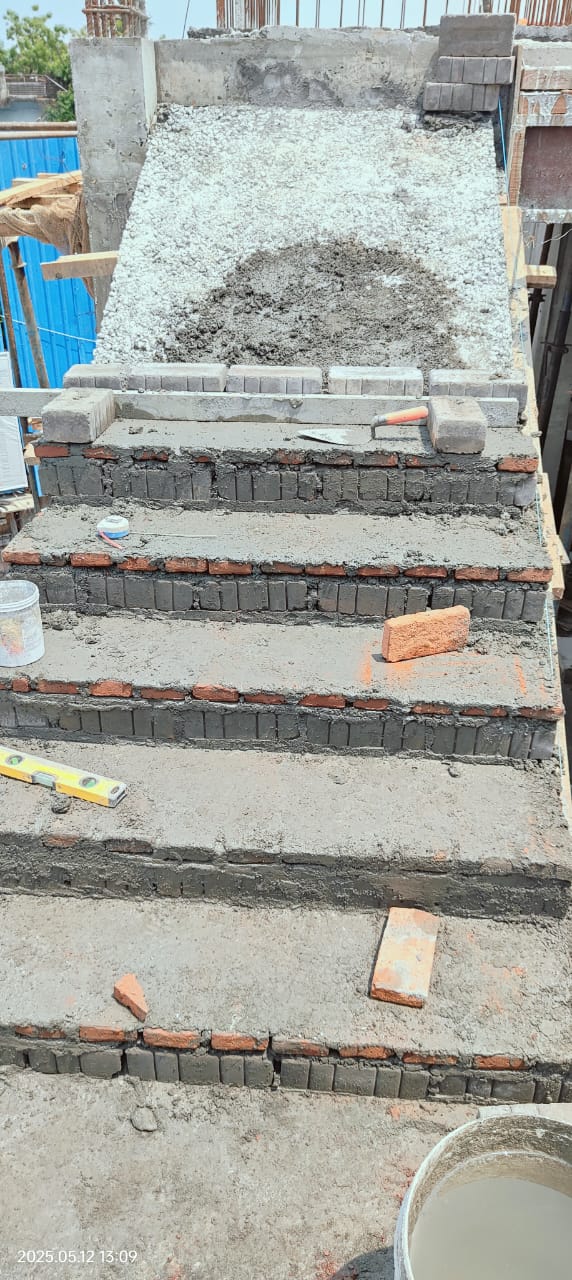

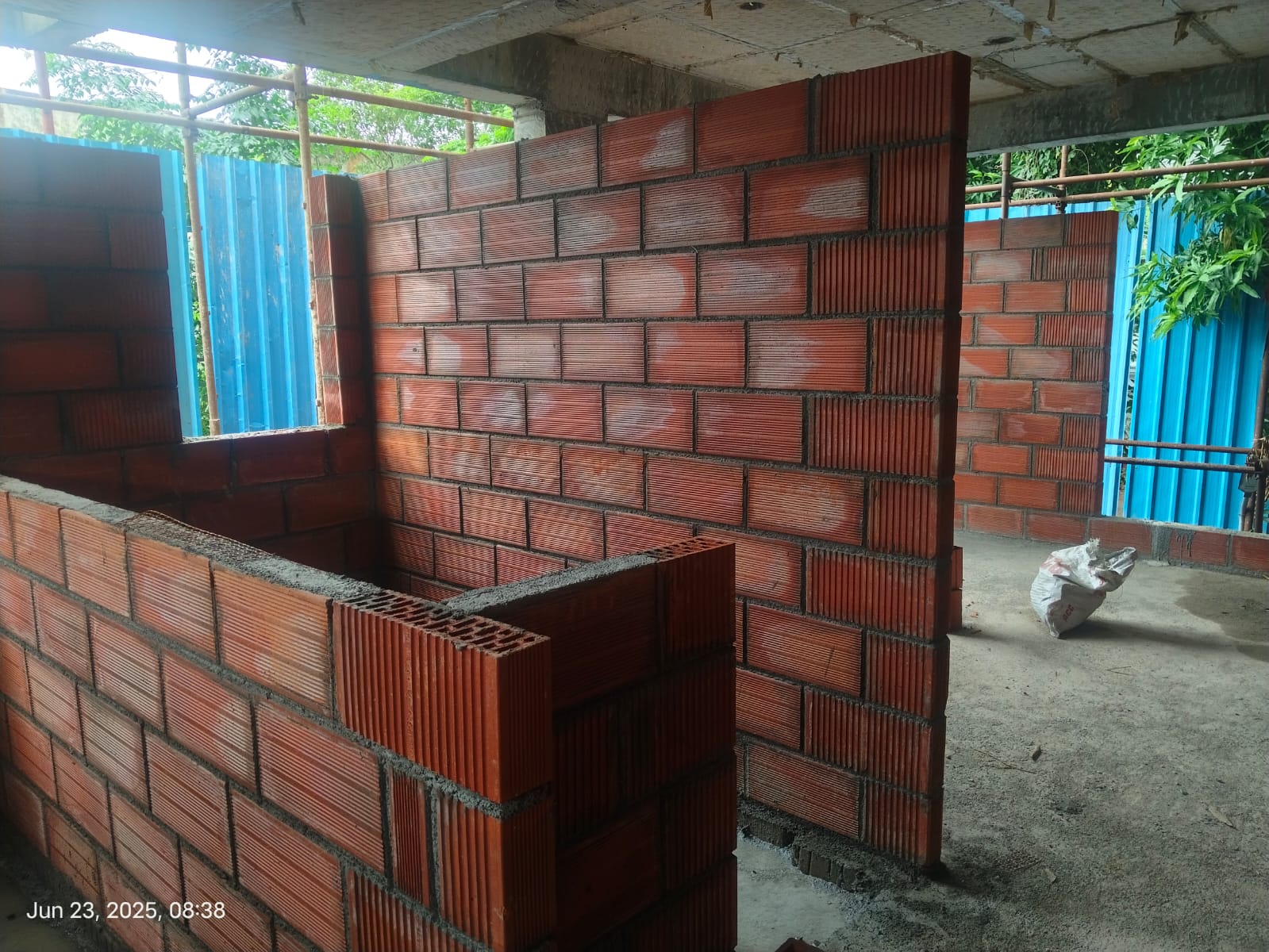

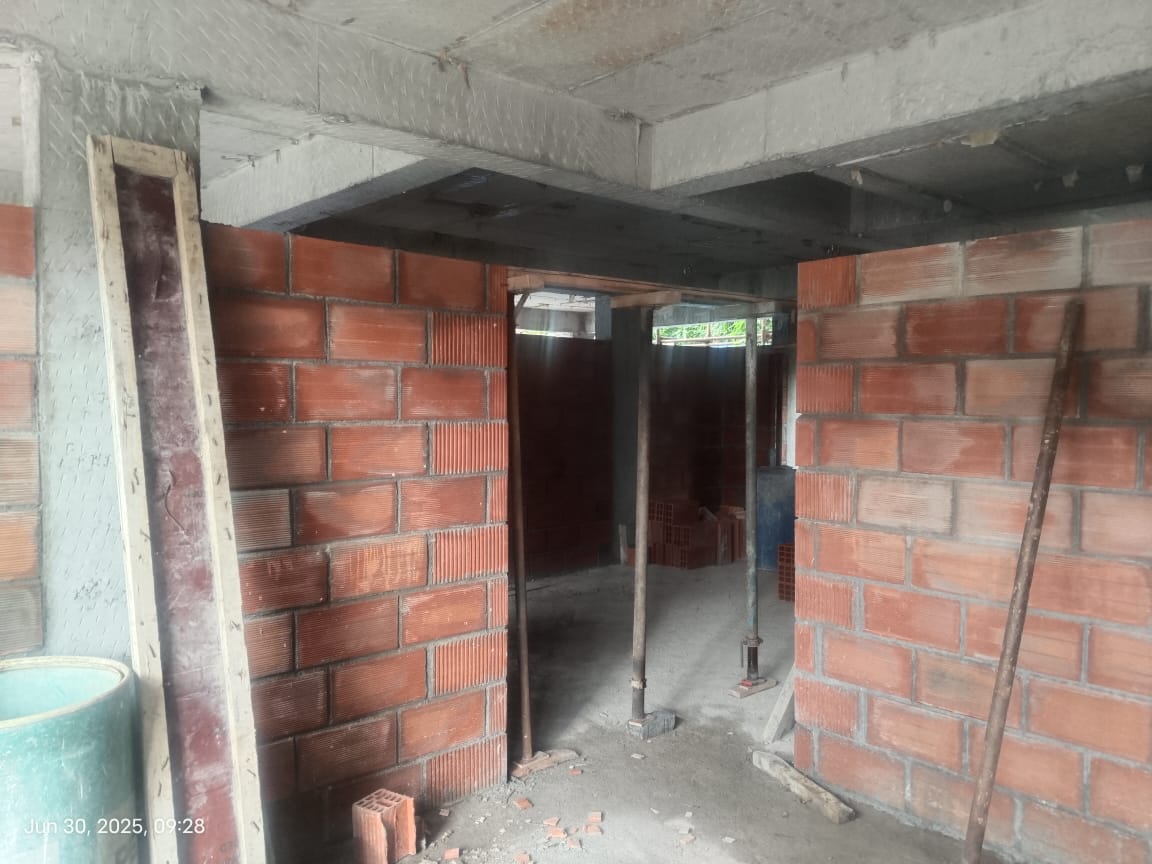

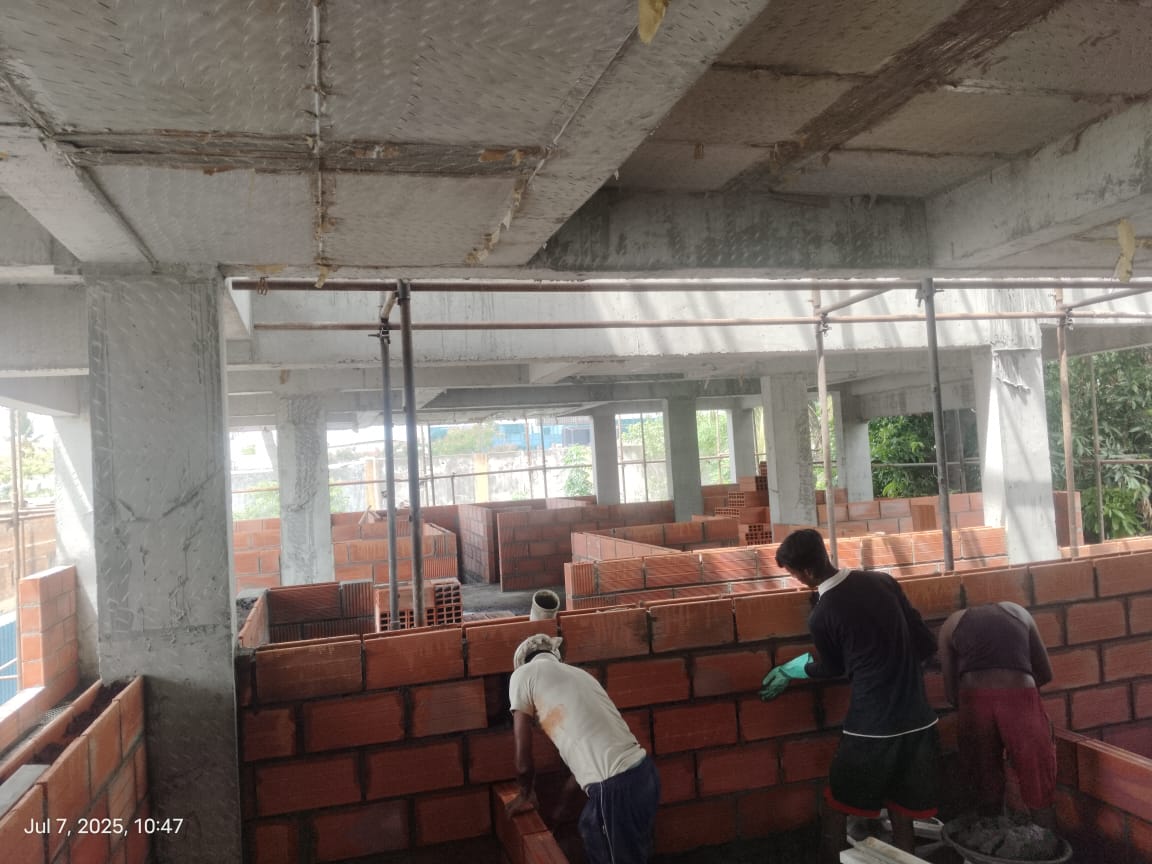

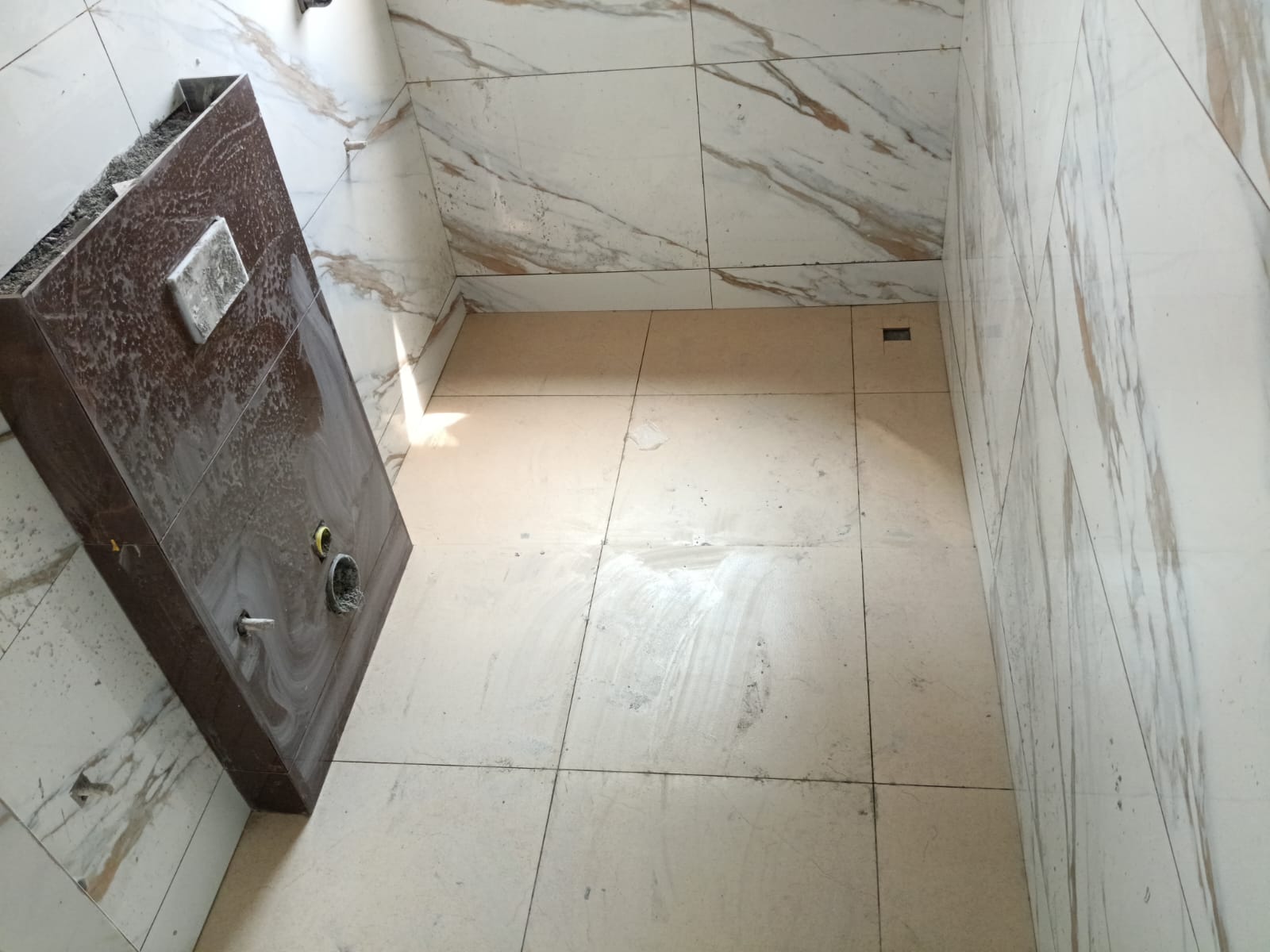

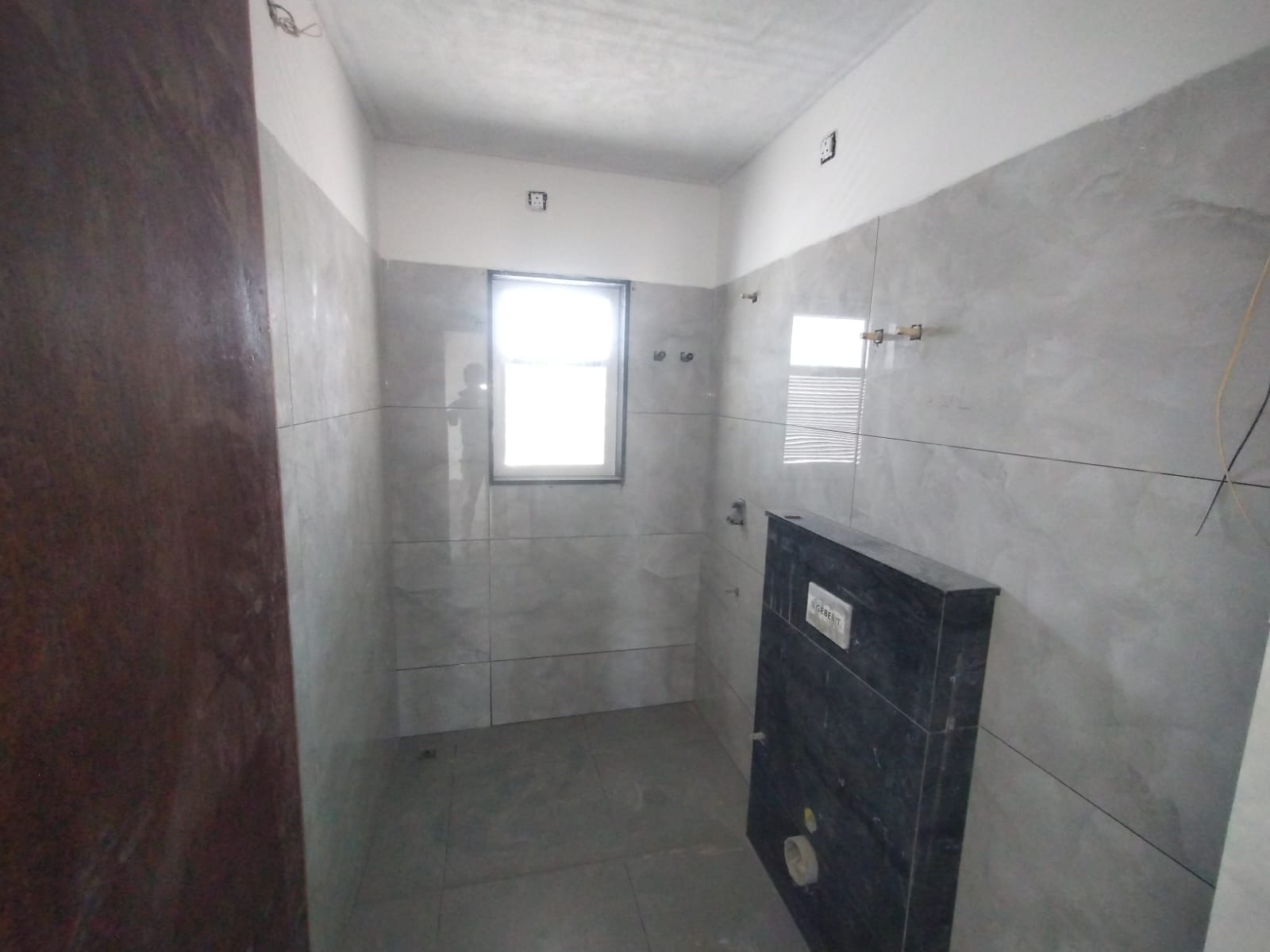

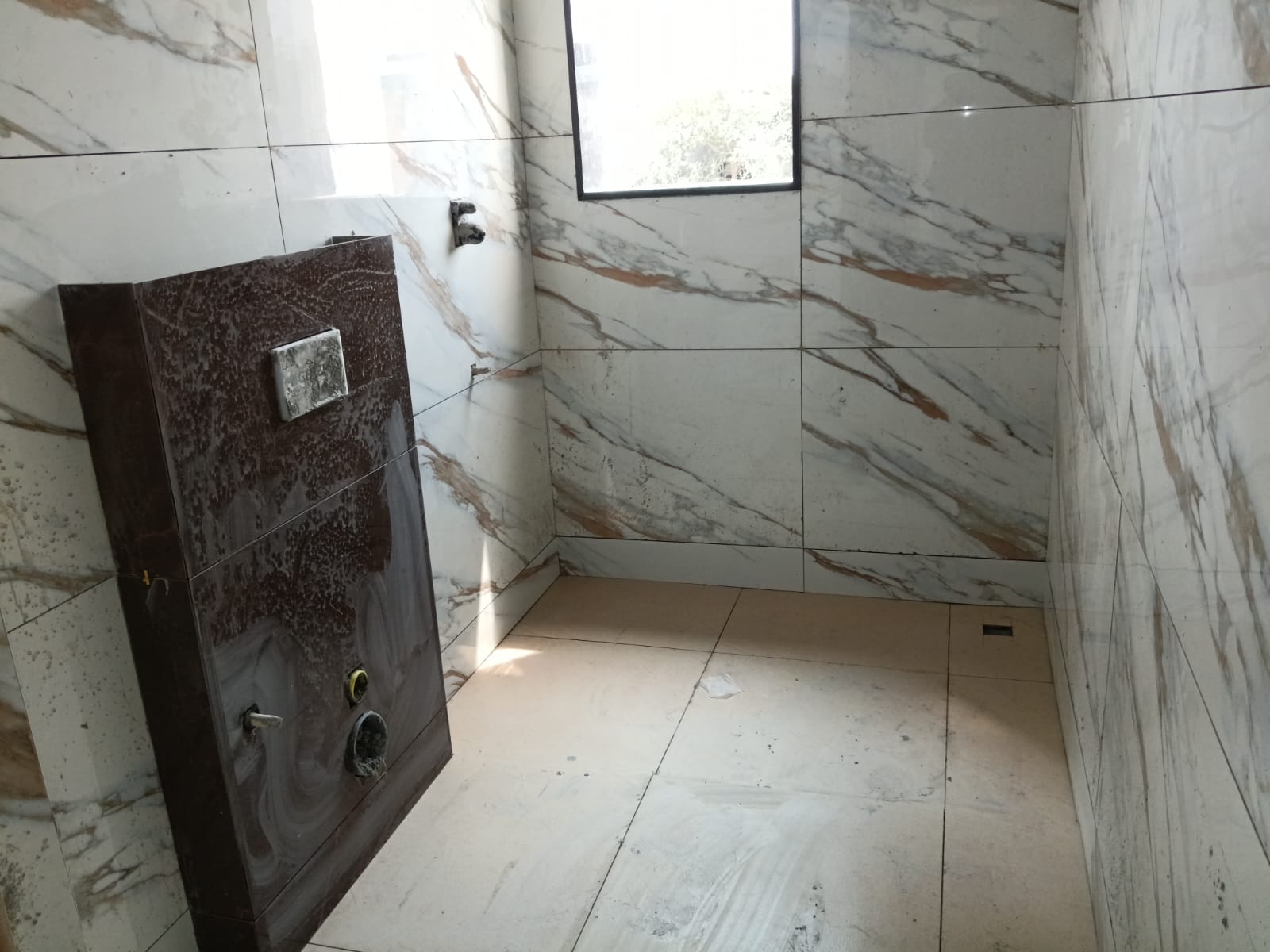

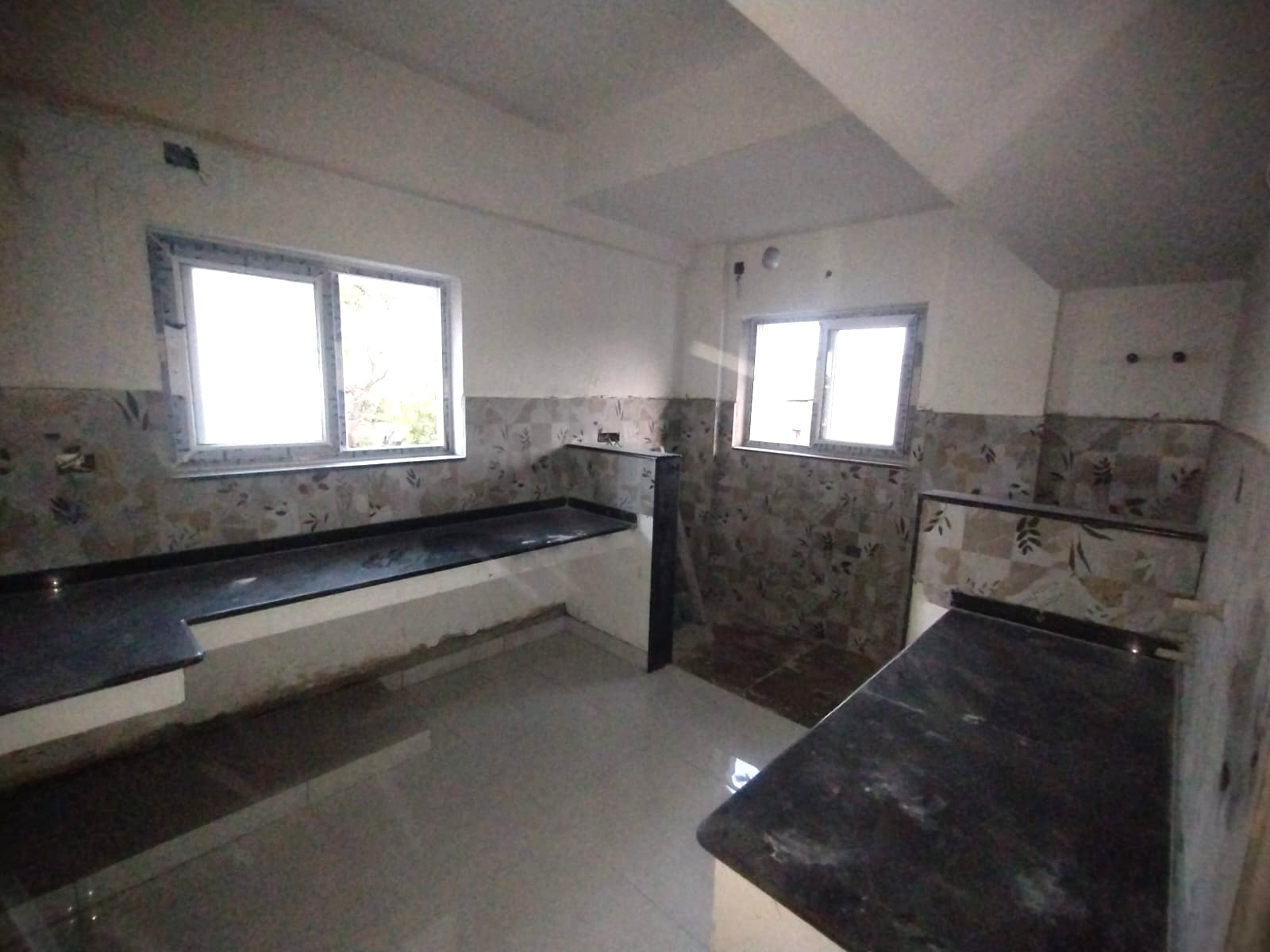

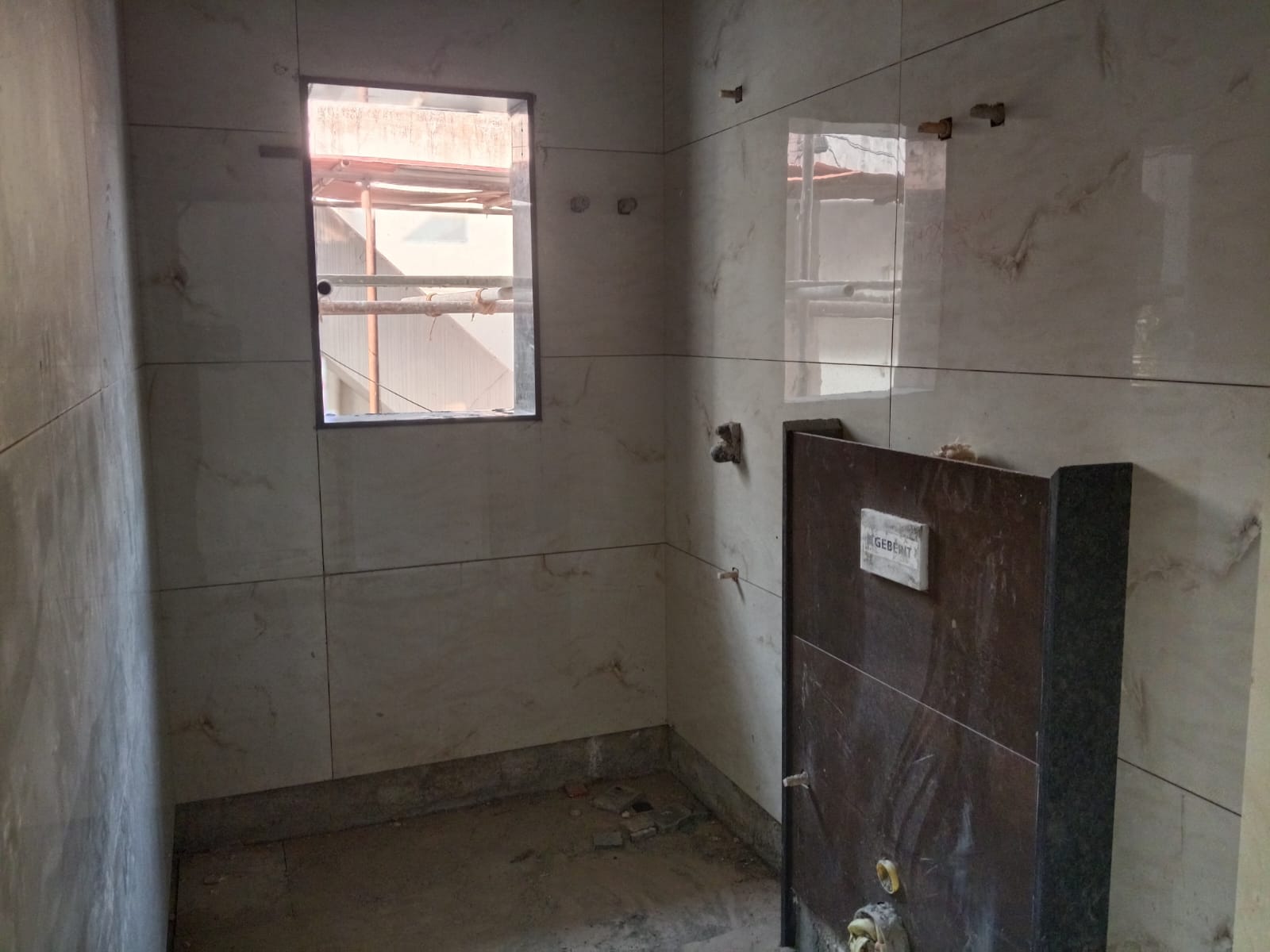

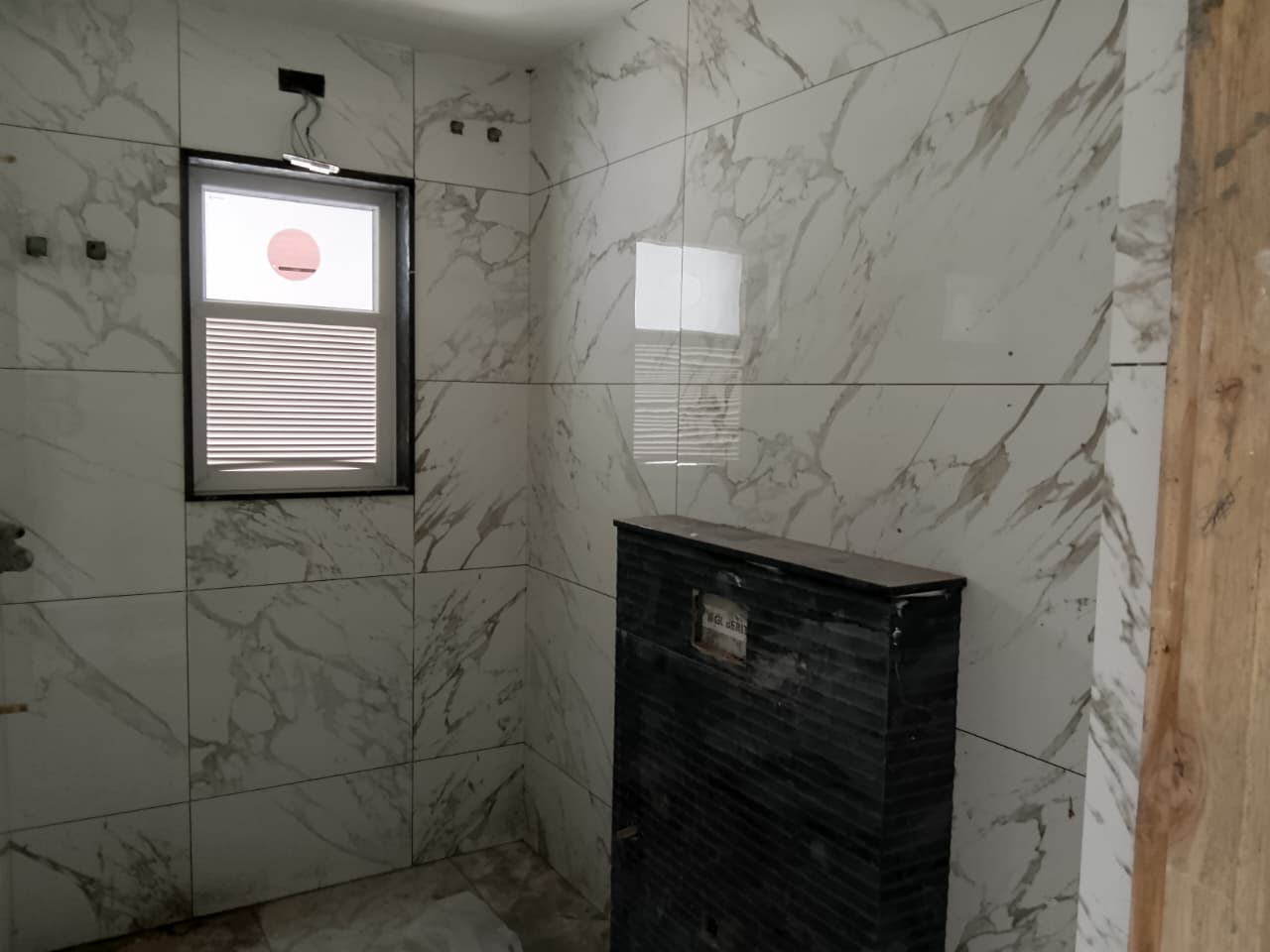

  • Toilet wall tiles work is in progress. (up to 4th floor completed ,5th floor 50% completed)

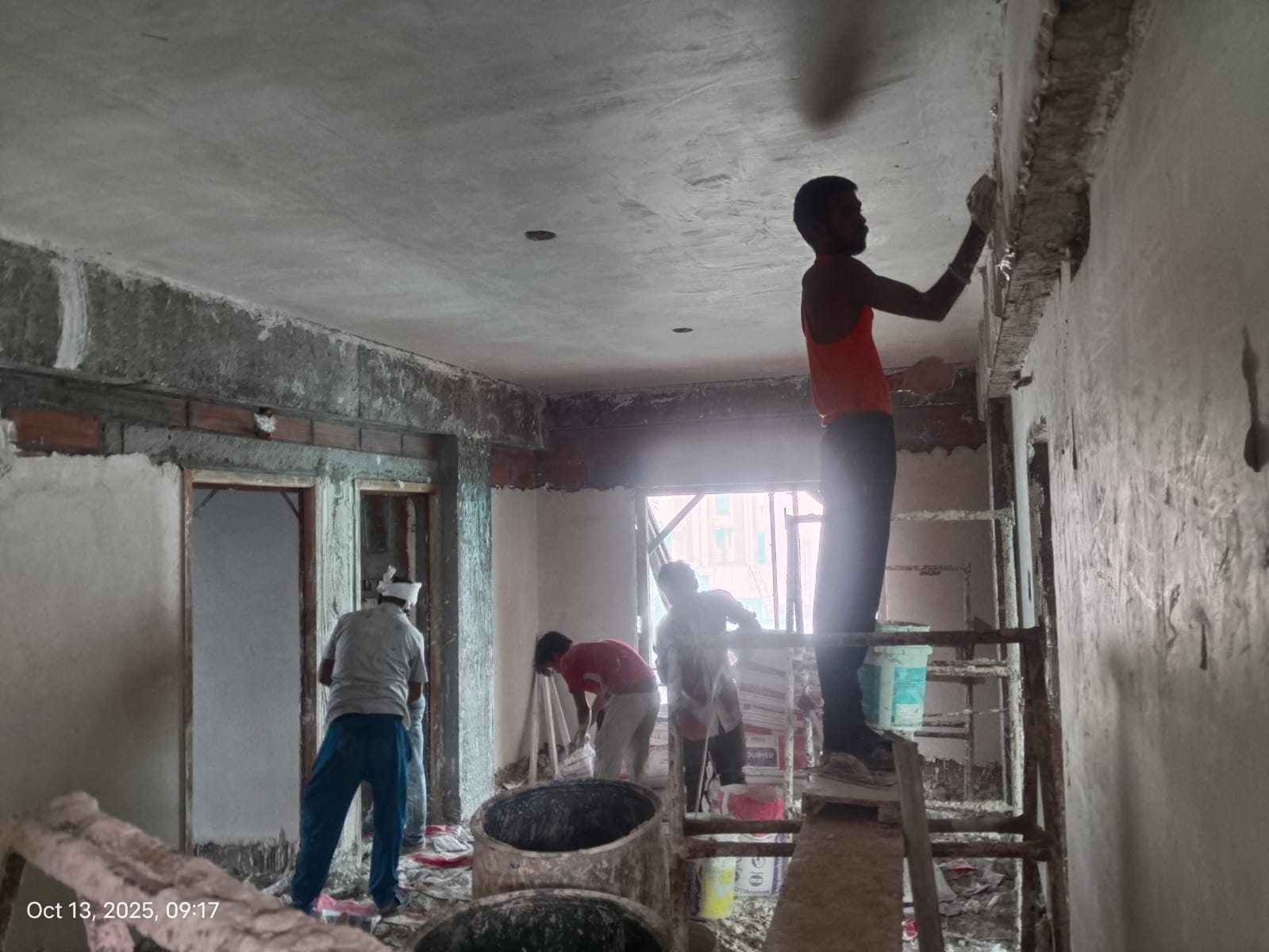

  • Inner primer work is in progress. (Upto 4th floor completed)

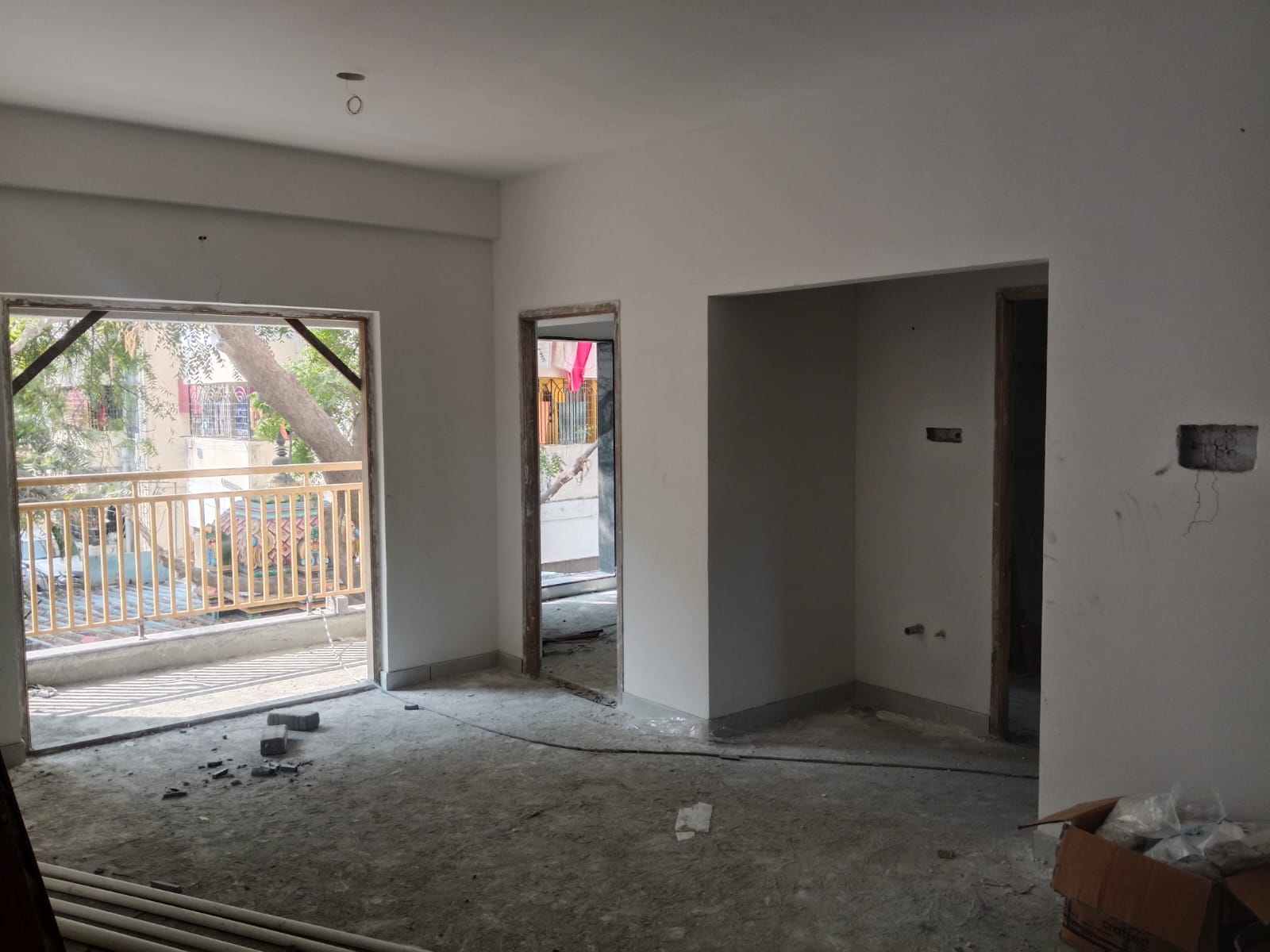

  • Main flooring tiles work is in progress. (Upto 4th floor completed, 5th floor 80% completed).

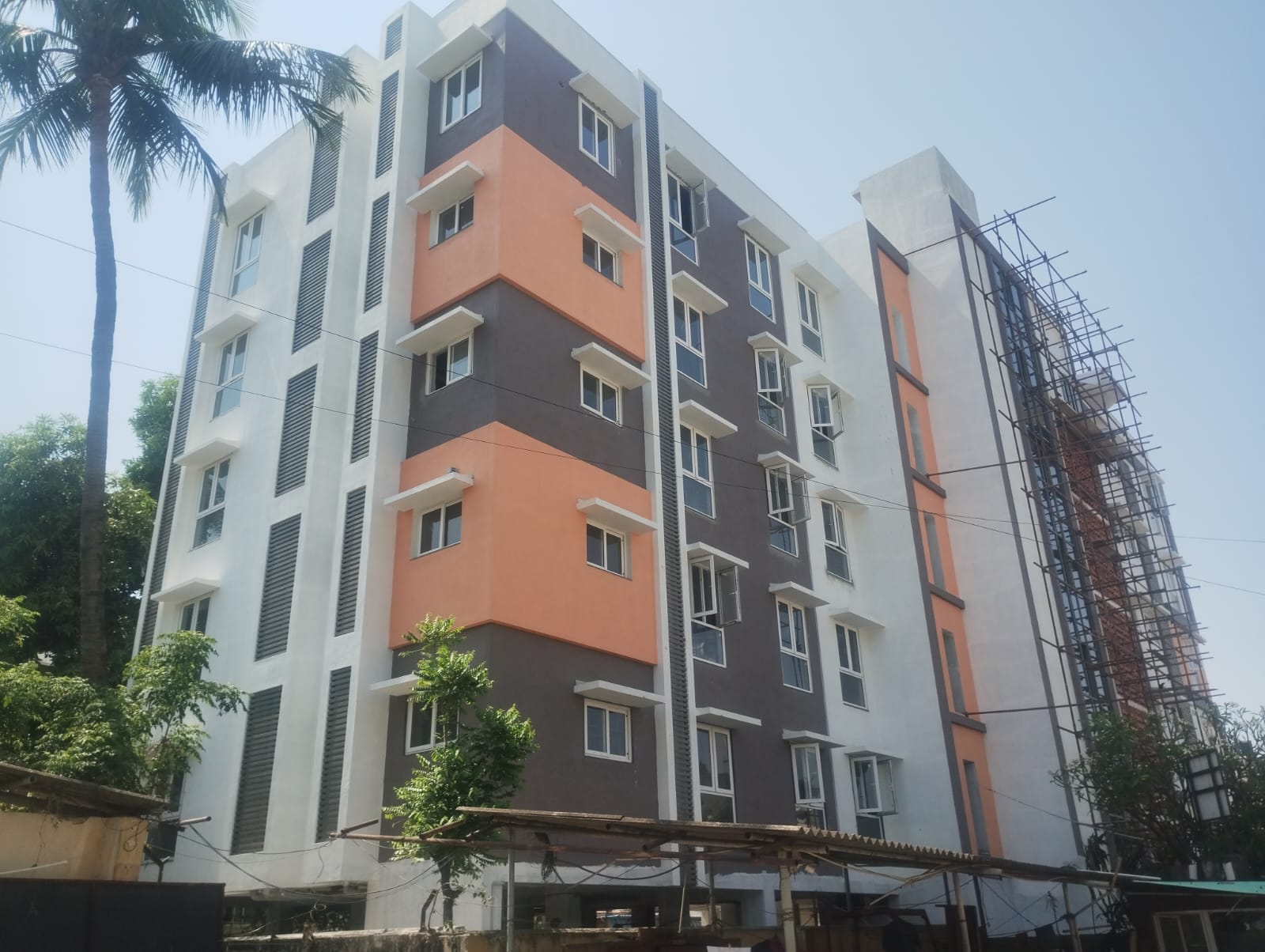

  • External 1st coat painting work is completed.
  • Lift erection work is in progress.(90% completed)
  • Elevation terracotta jalli work is in progress.(30% completed)

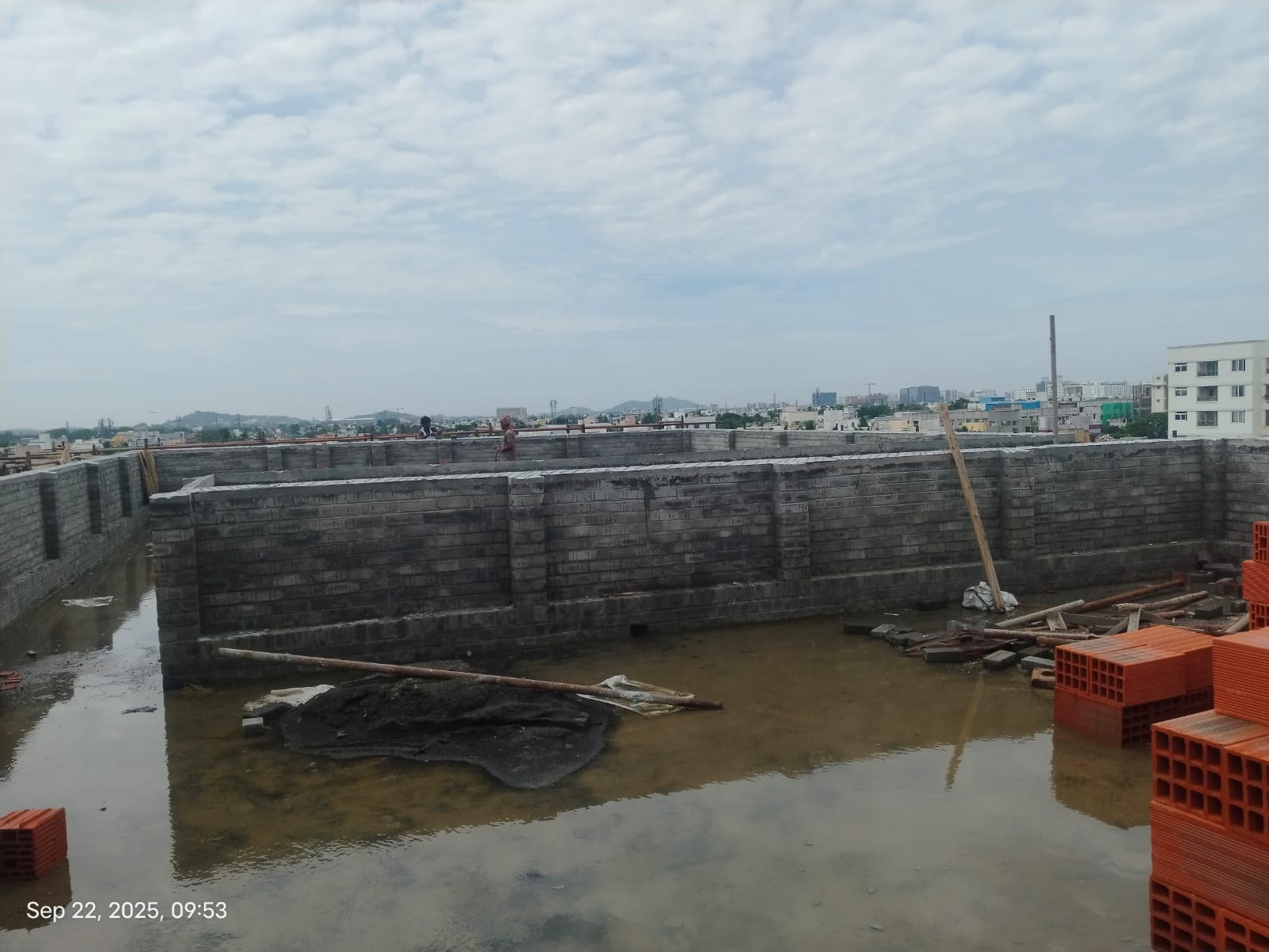

  • External chamber work is in progress.(90% completed)
  • Compound wall work is in progress. (80% completed)

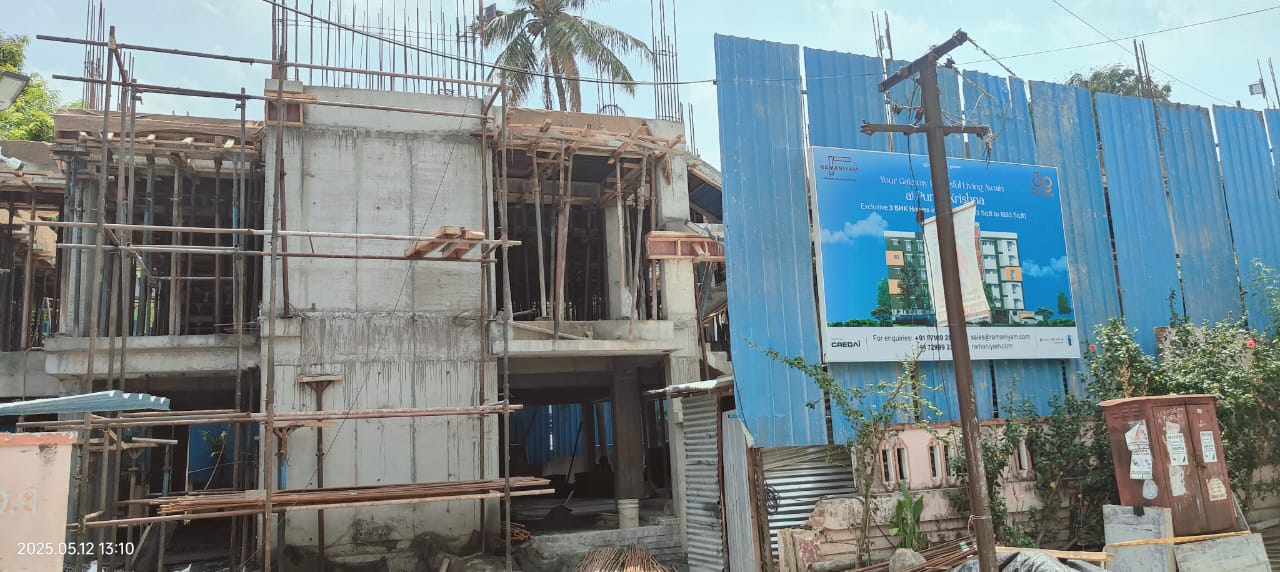

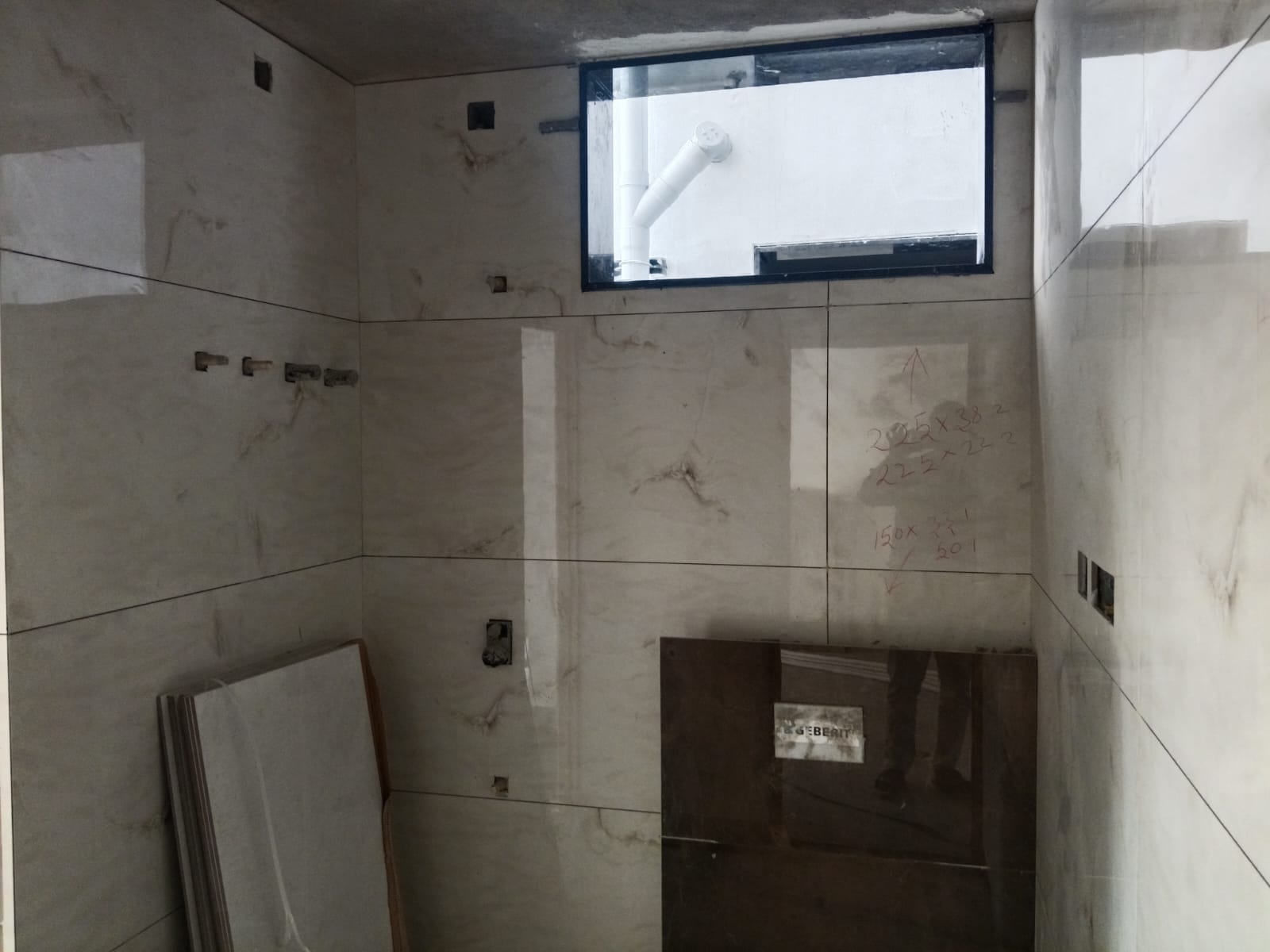

  • Toilet wall tiles work is in progress. (up to 4th floor completed ,5th floor 70% completed)

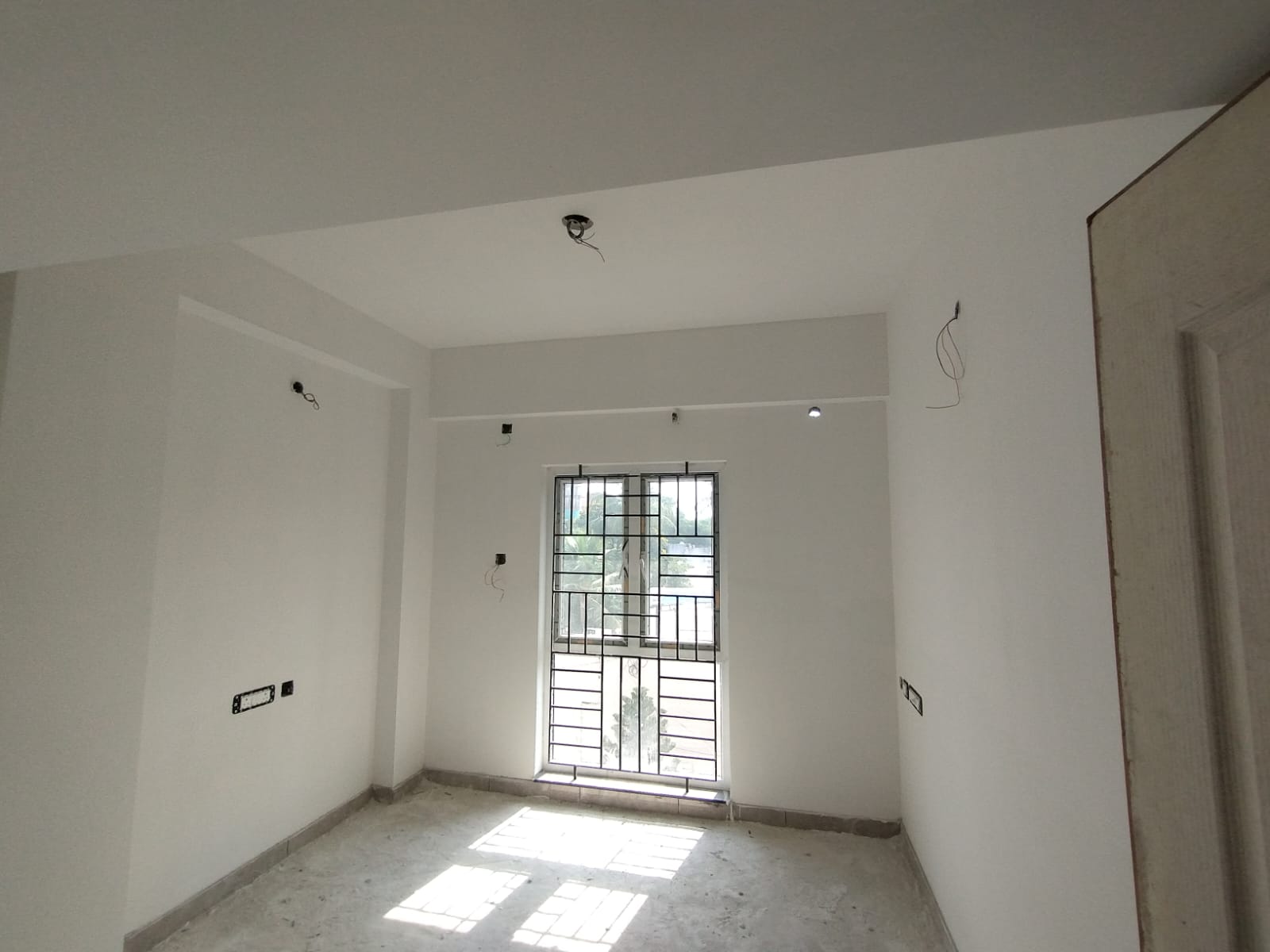

  • Inner primer work is in progress. (Upto 4th floor completed)
  • Main flooring tiles work is in progress. (Up to 4th floor completed, 5th floor 90% completed).
  • Elevation terracotta jalli work is in progress.(30% completed)
  • External chamber work is in progress.(90% completed)

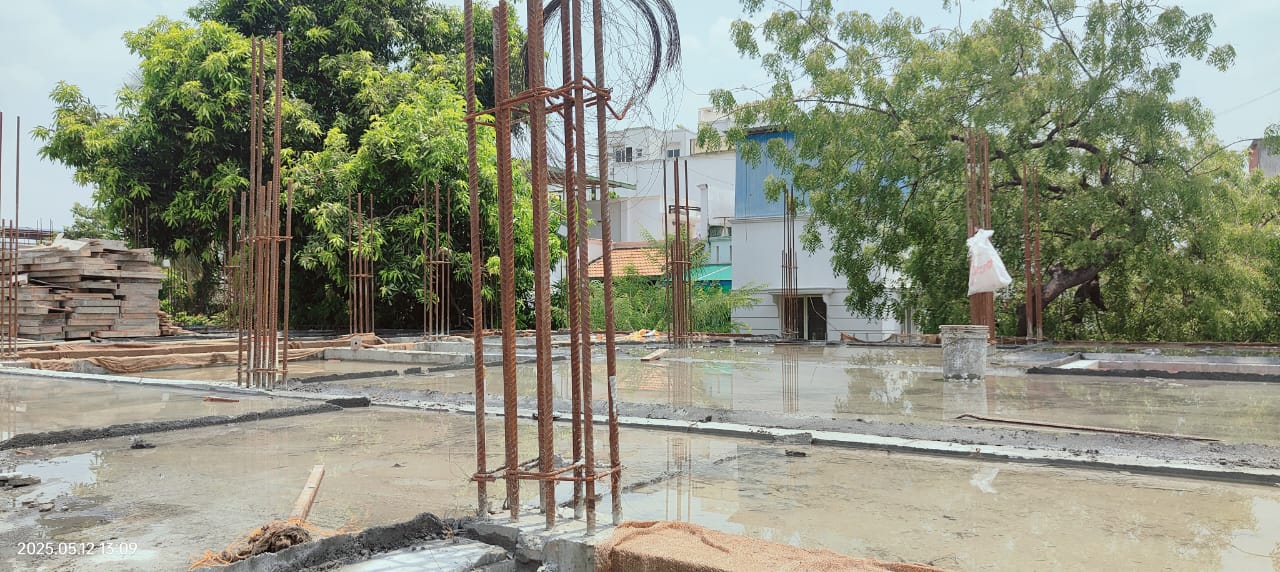

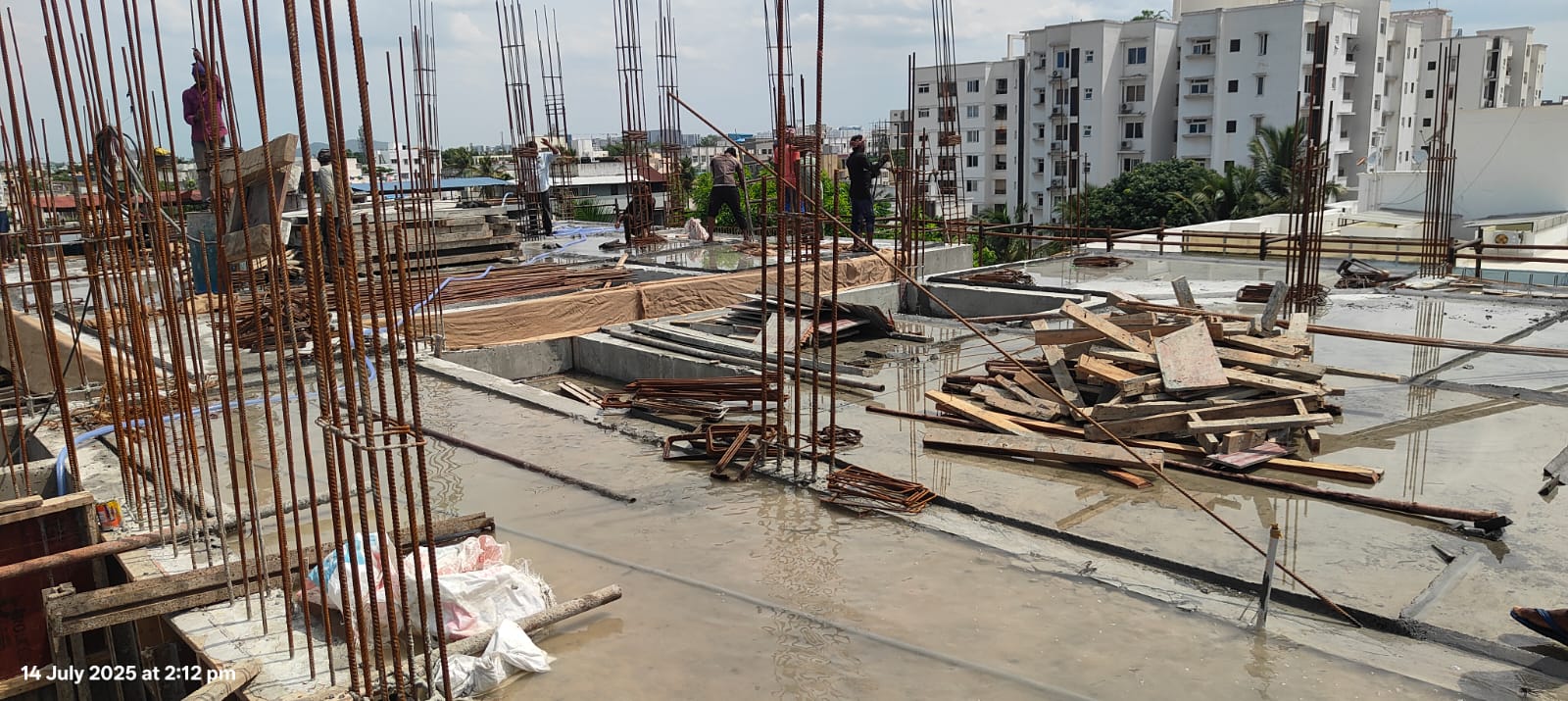

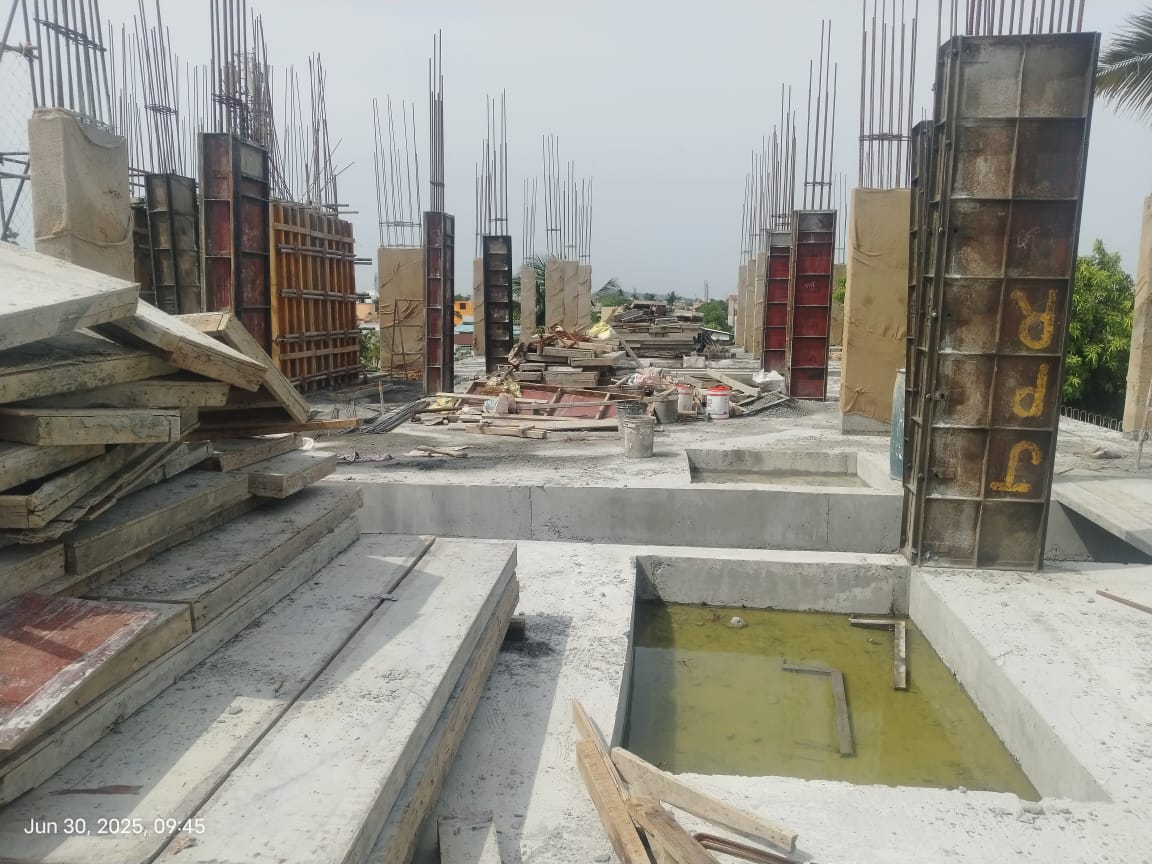

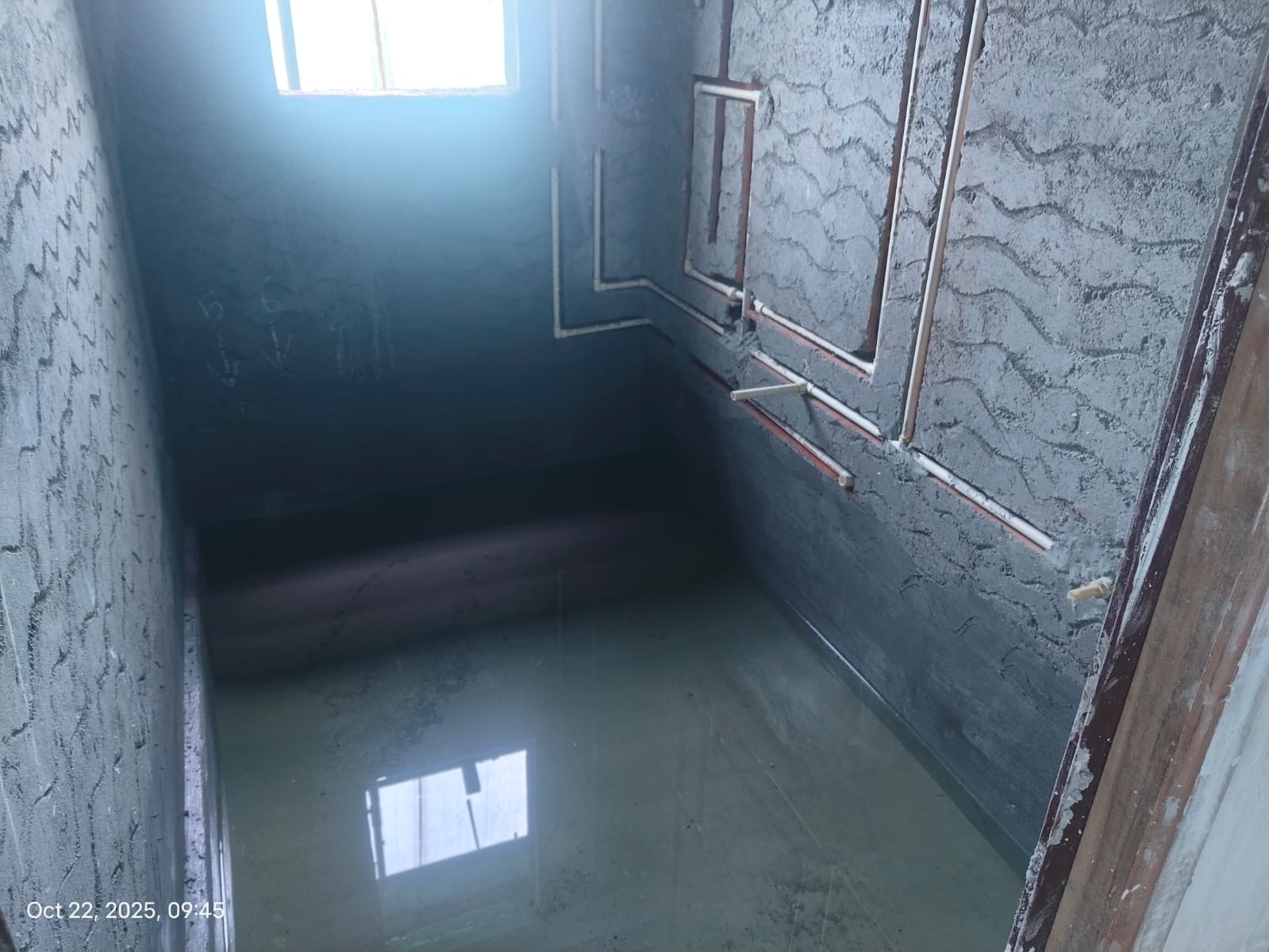

  • Set back earth filling work is in progress.(75% completed)
  • Outer GSB filling work is in progress.(30% completed)

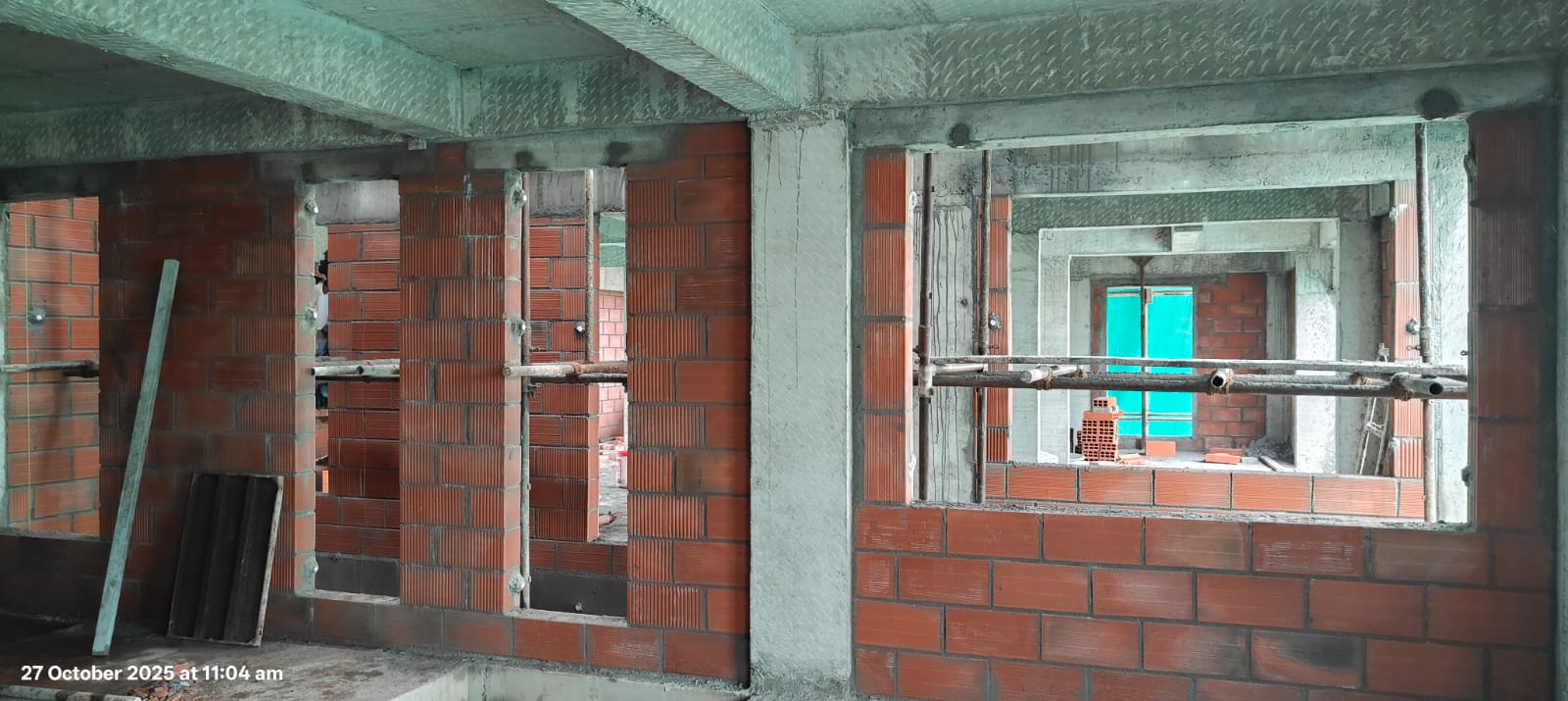

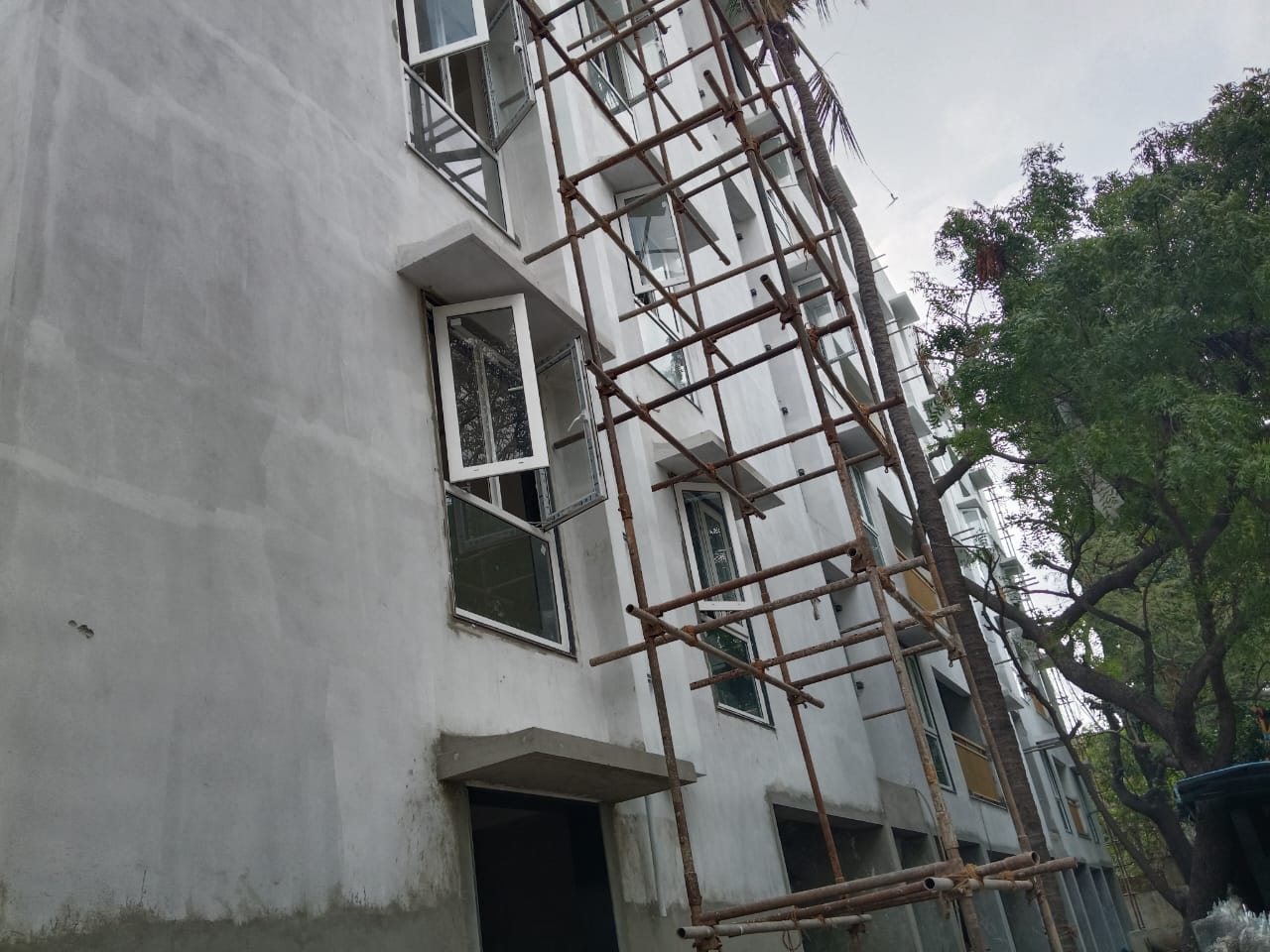

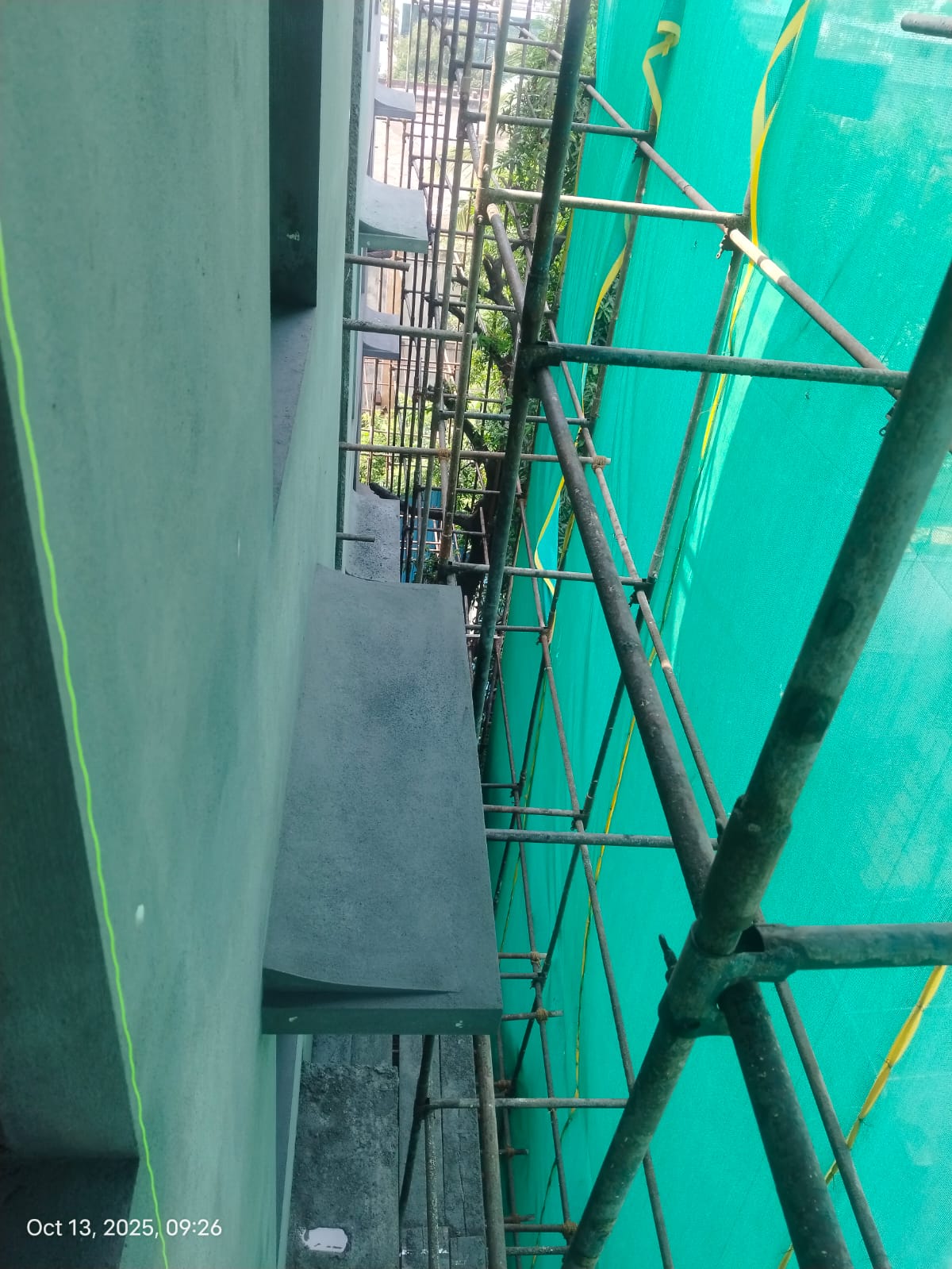

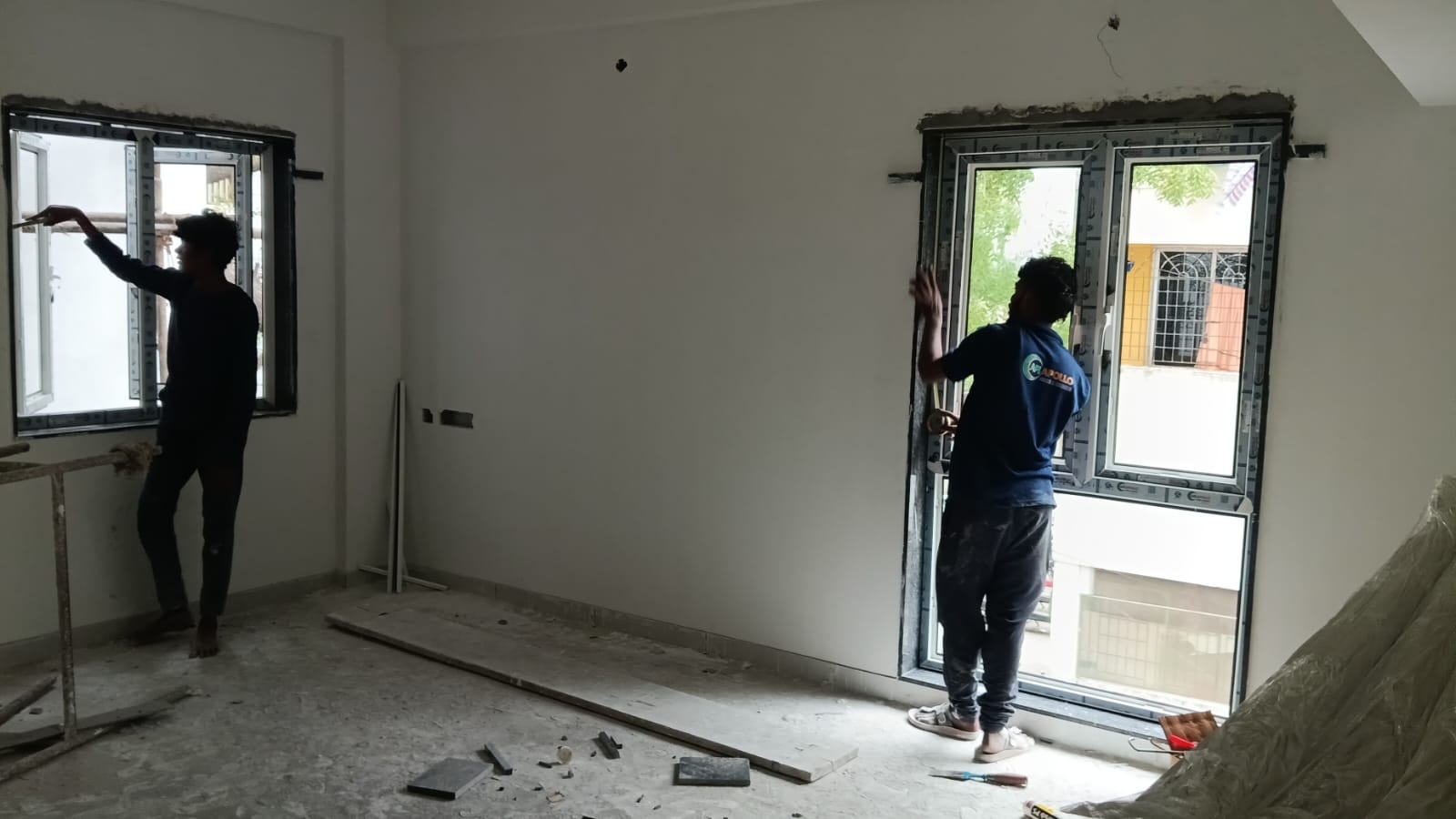

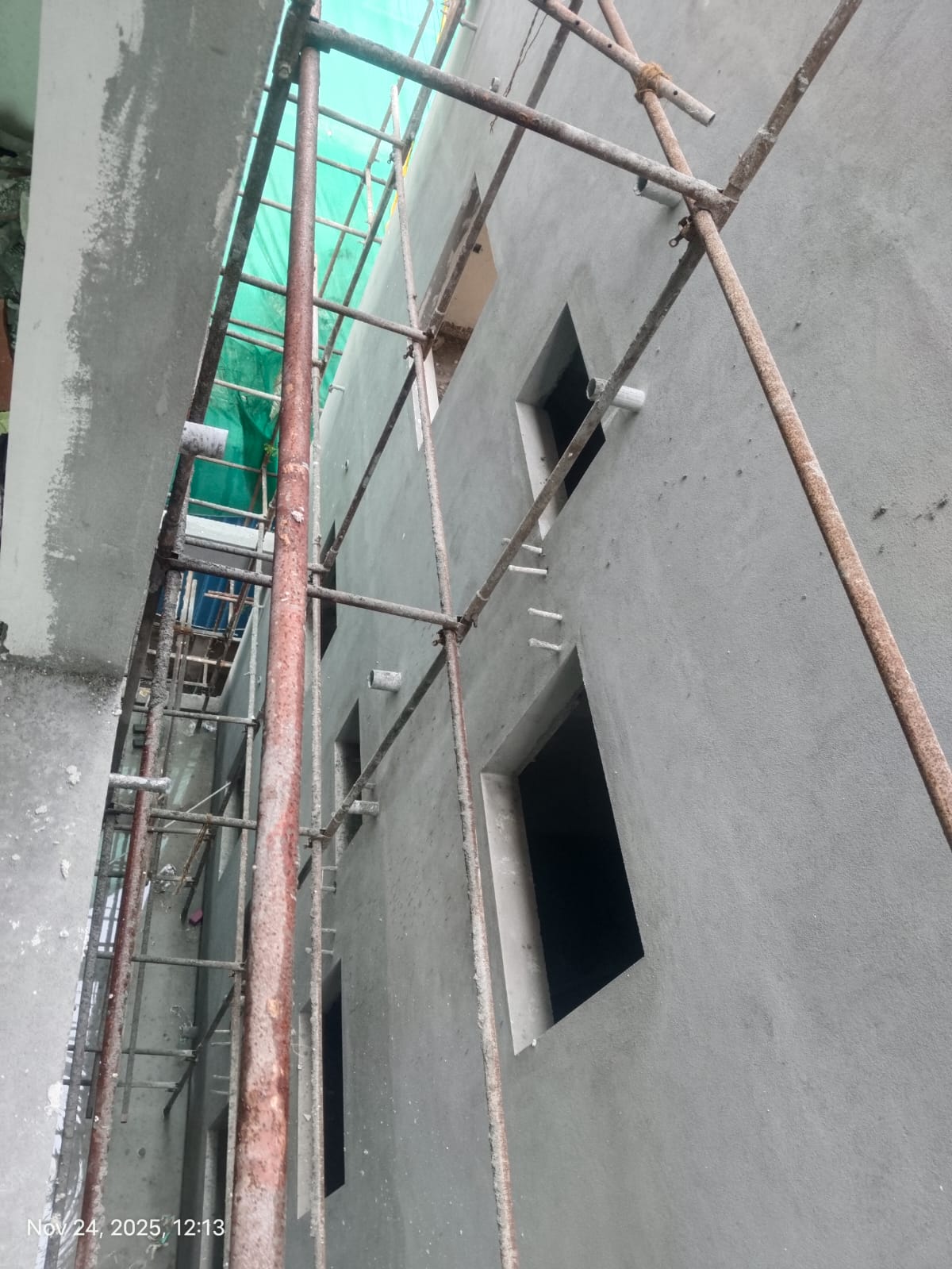

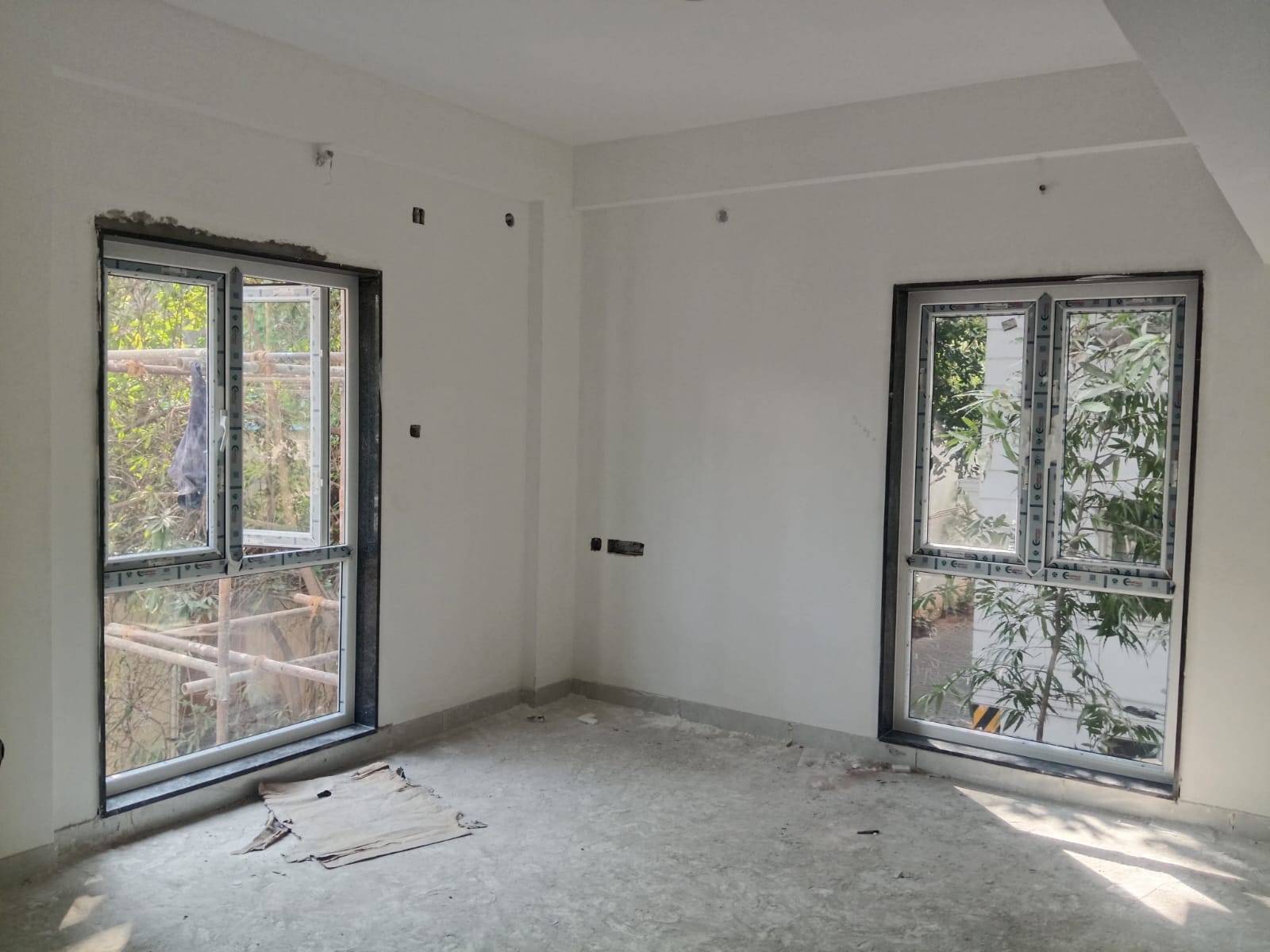

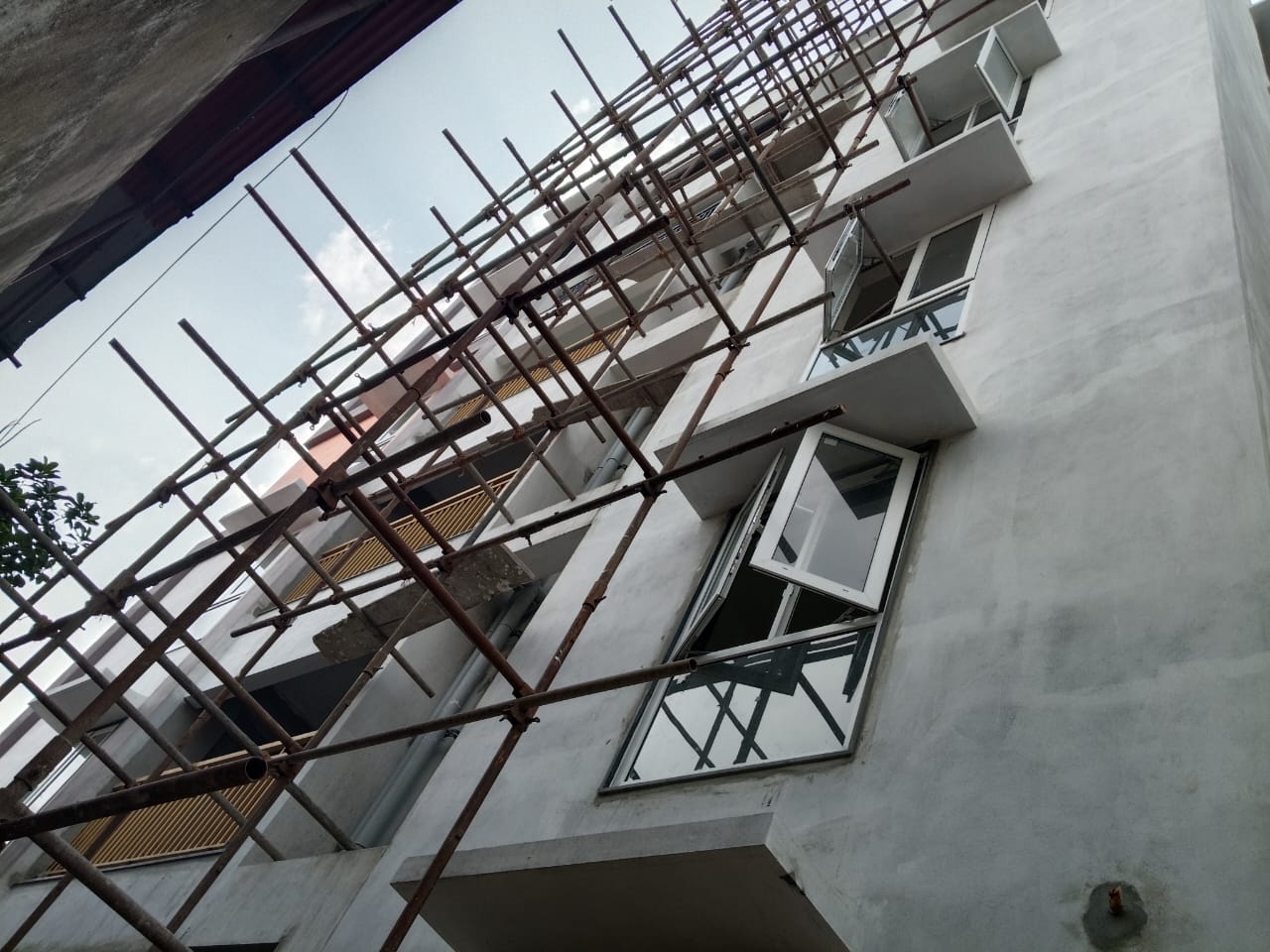

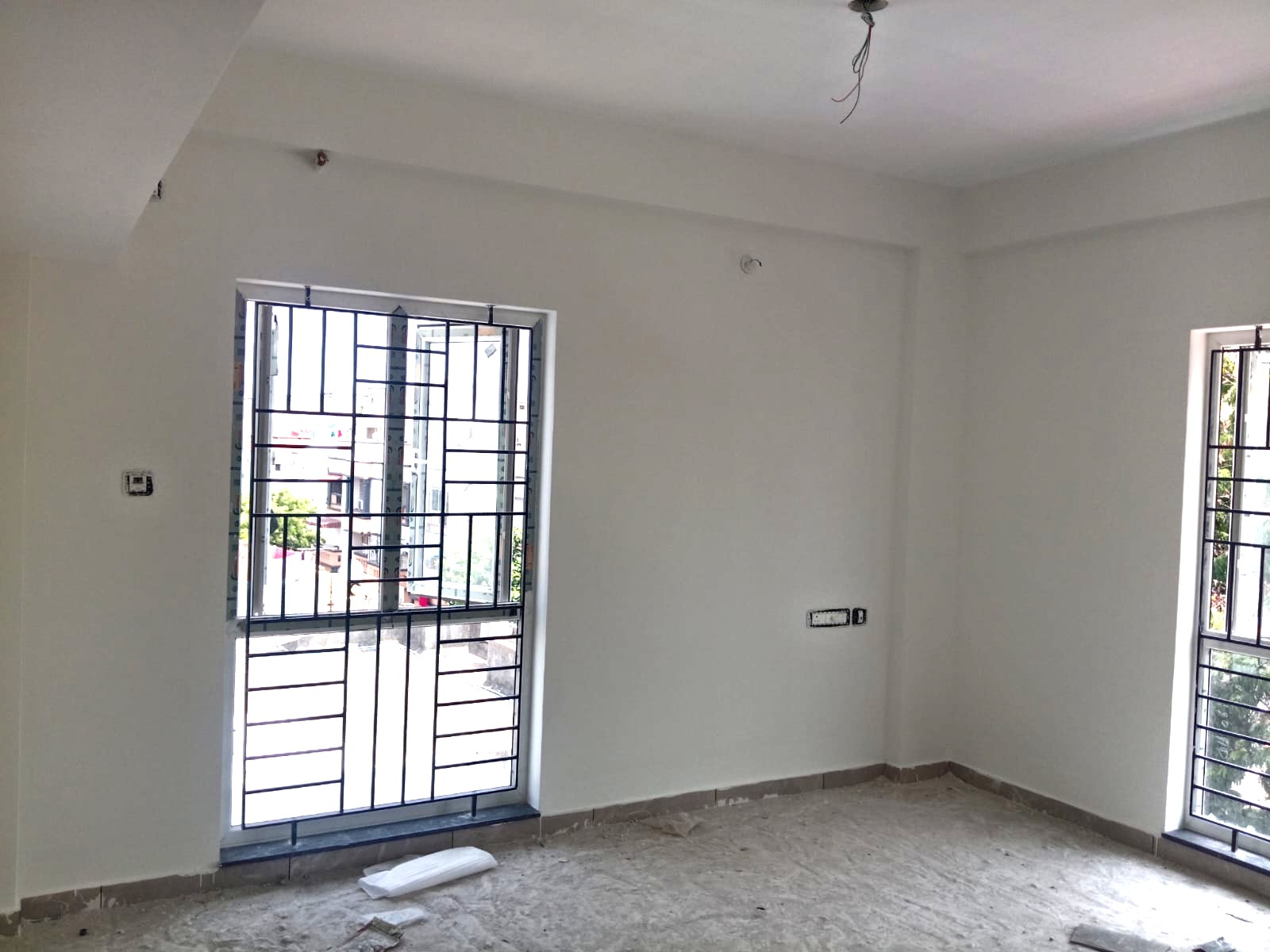

  • UPVC window fixing work is in progress.(Upto 4th floor completed,5th floor progress)
  • Compound wall work is completed.

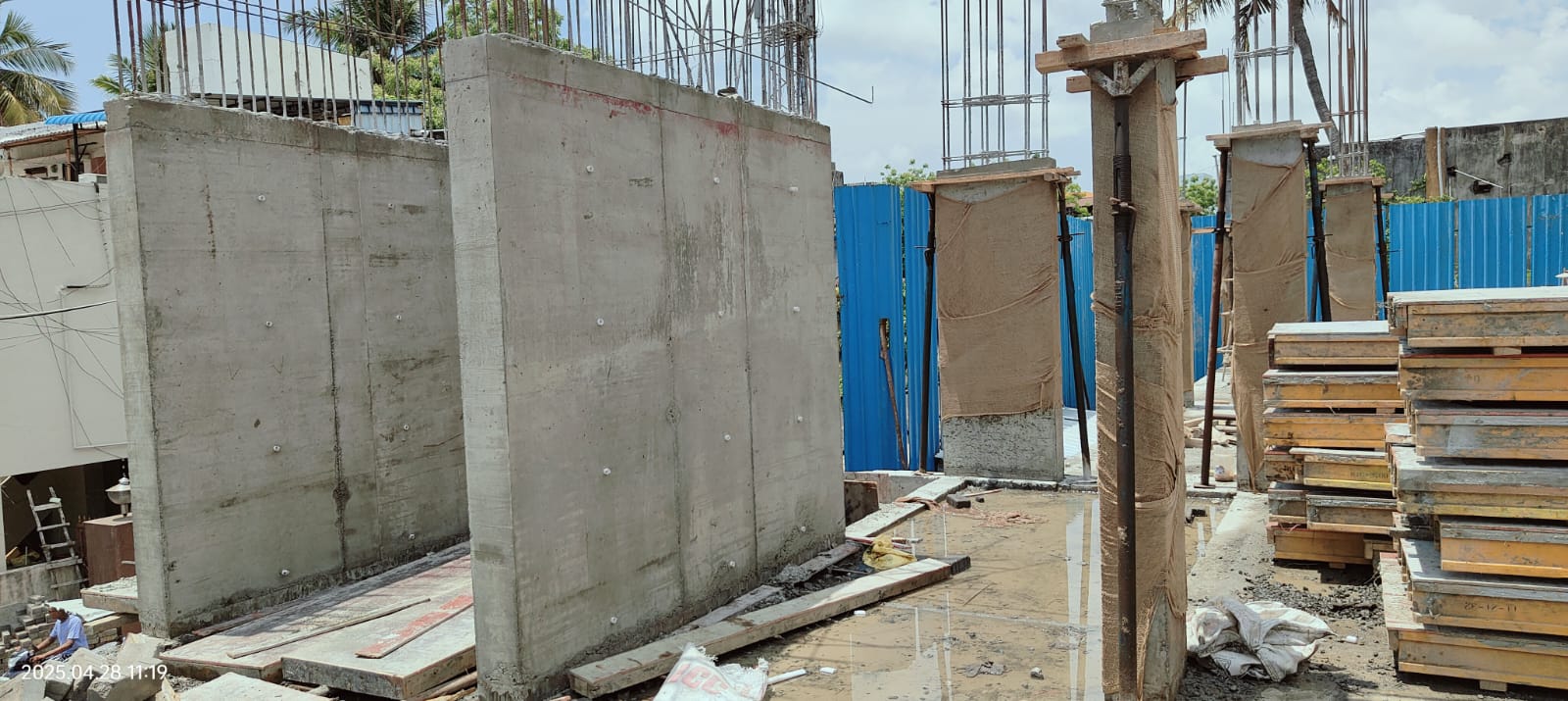

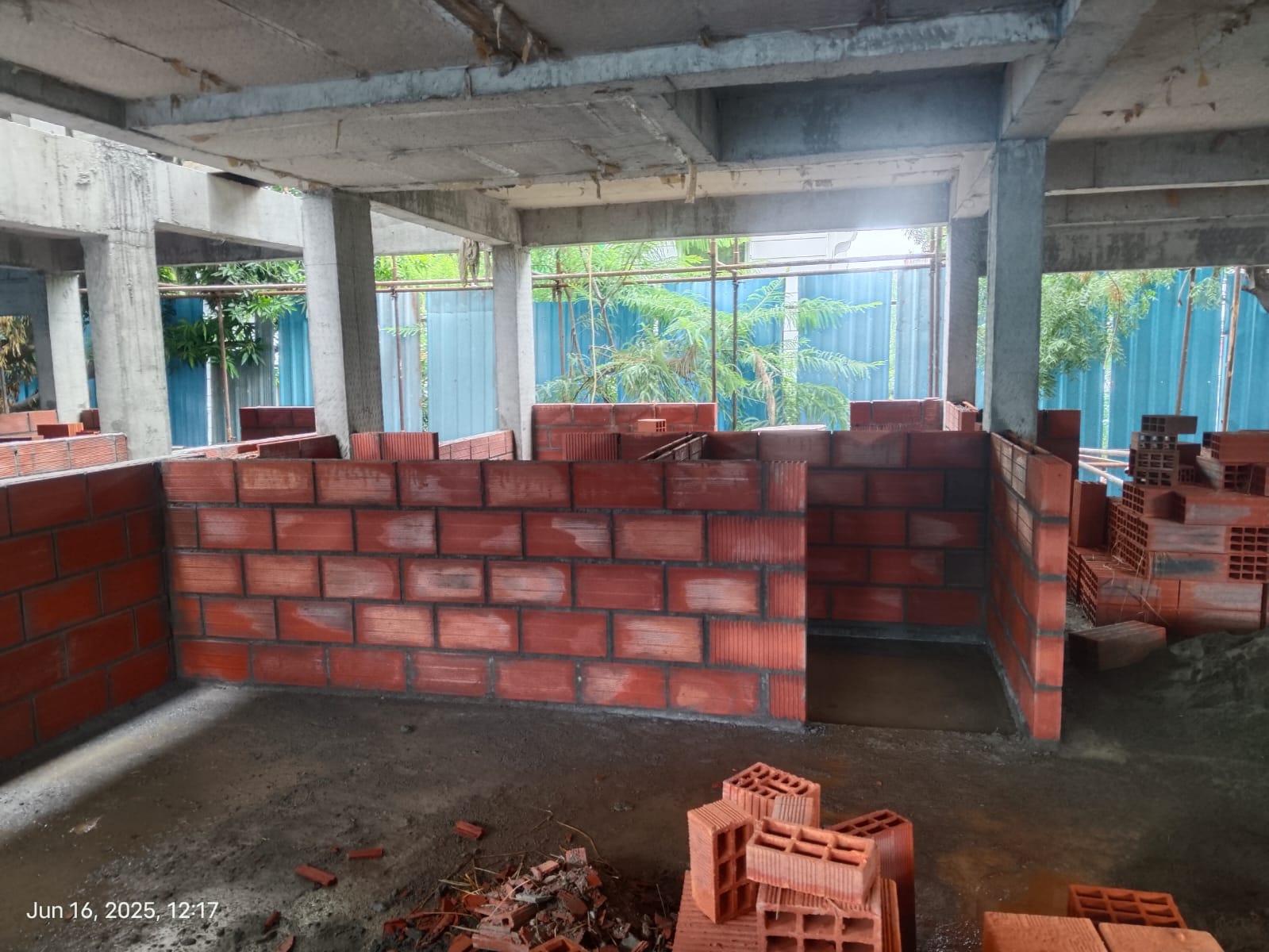

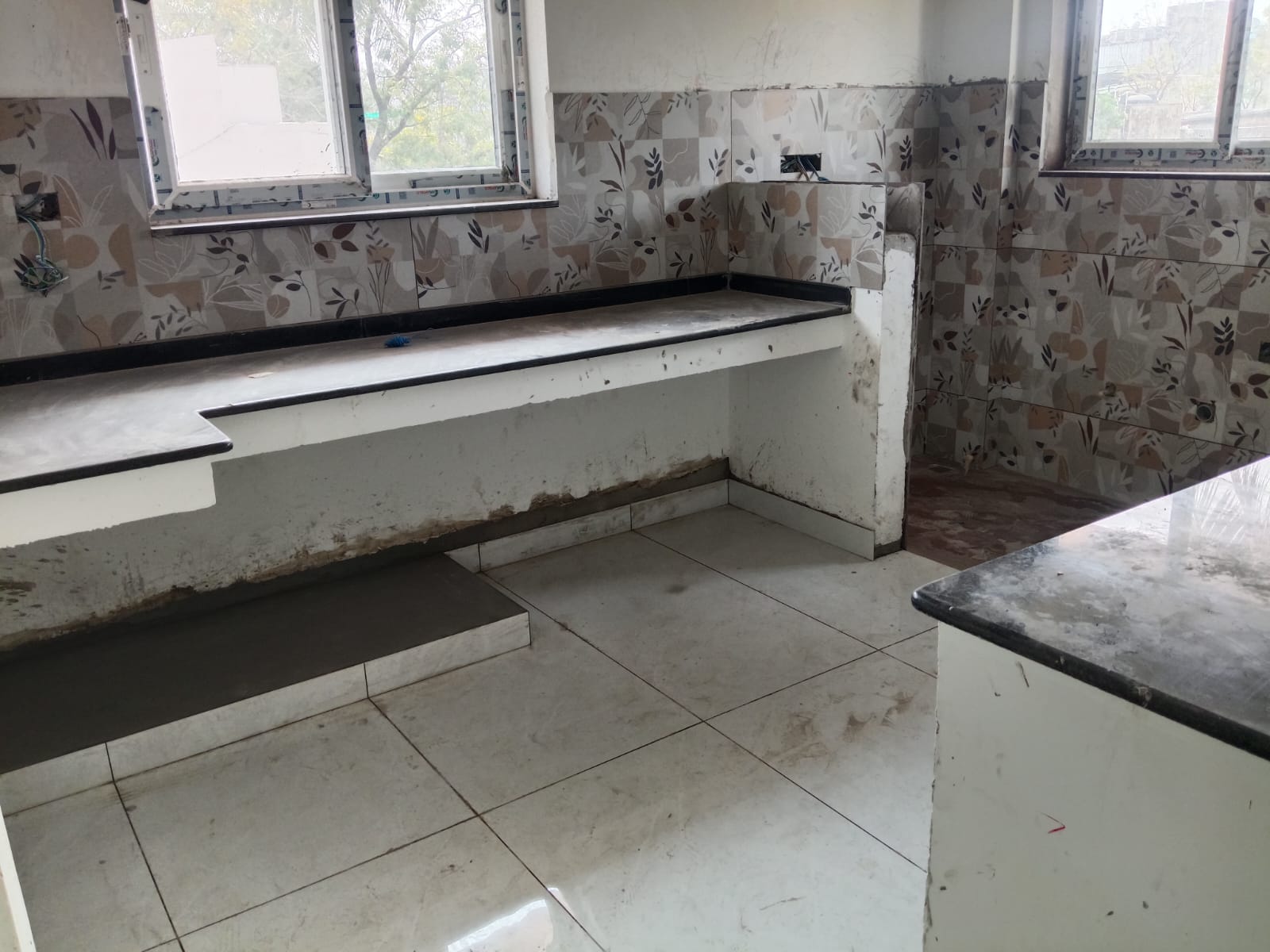

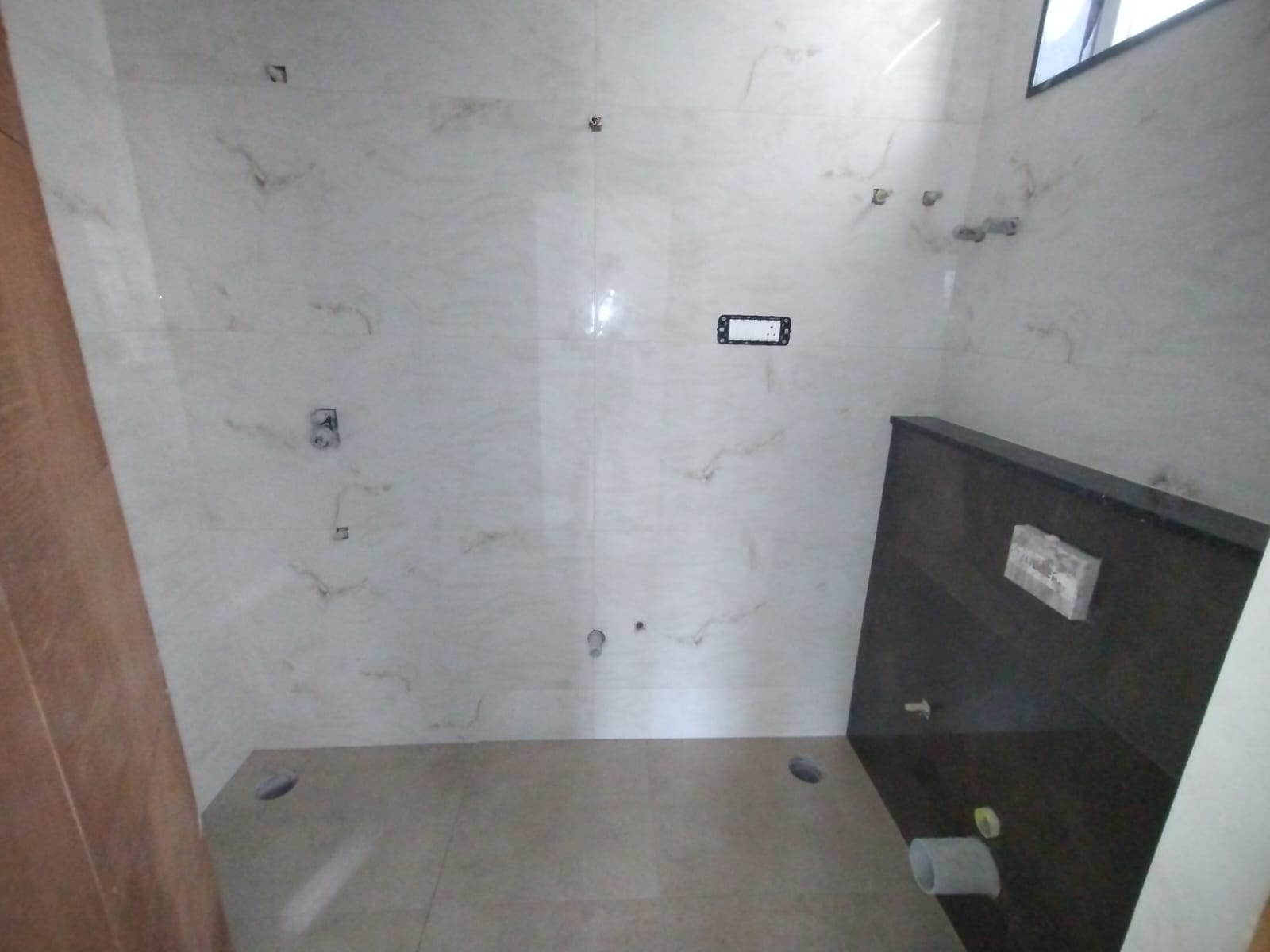

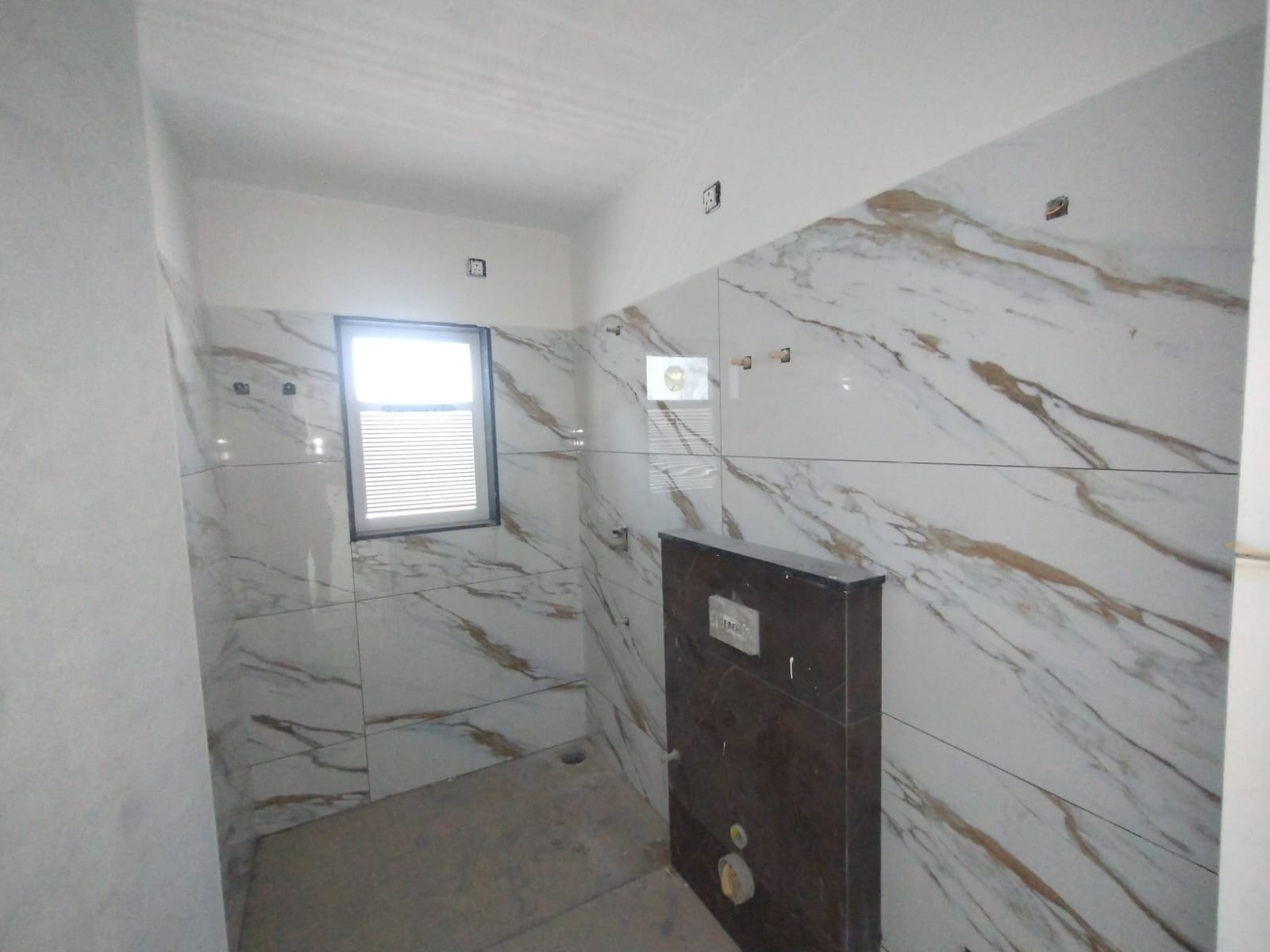

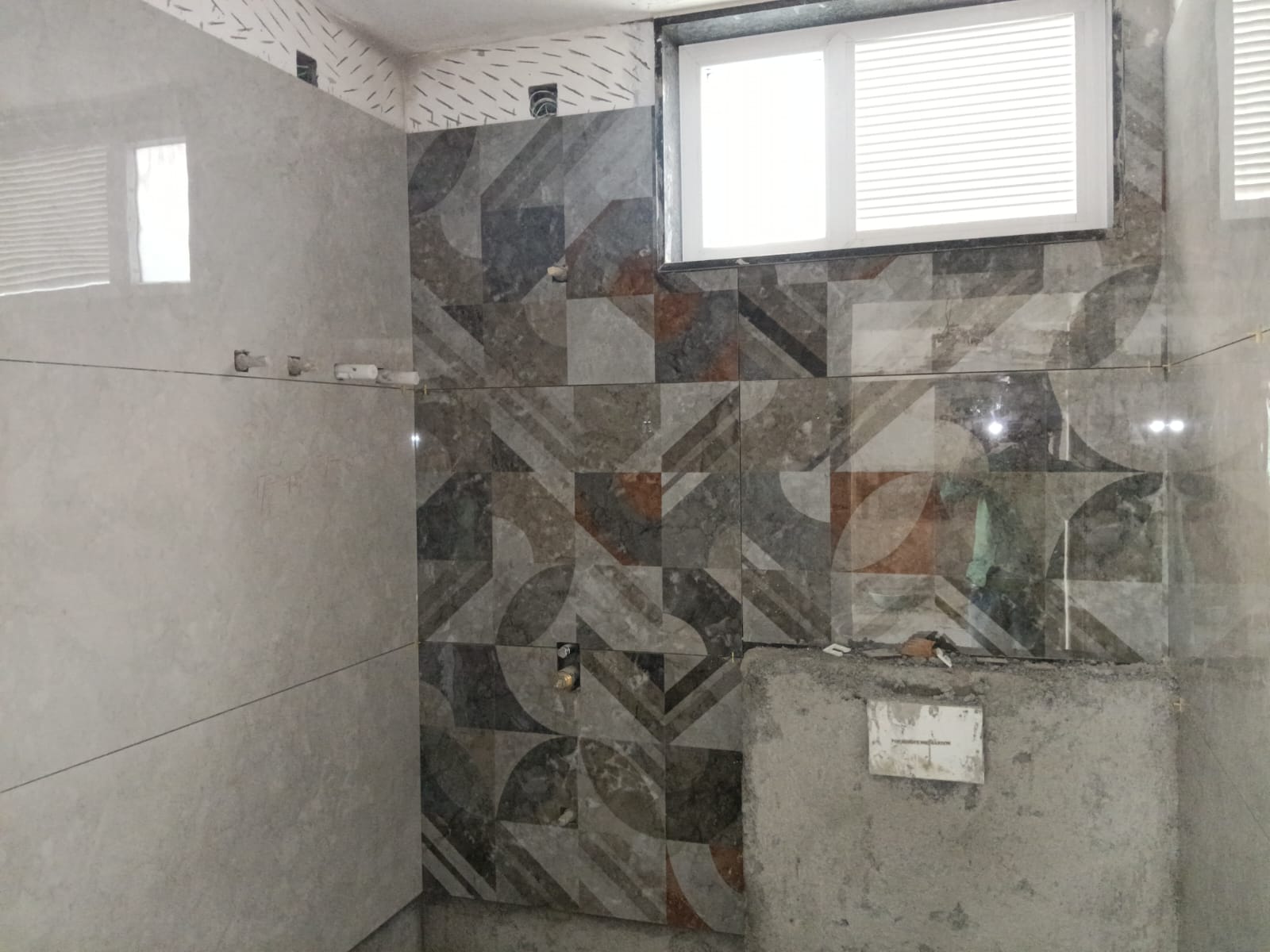

  • Toilet wall tiles work is in progress. (up to 5th floor completed)
  • Inner primer work is in progress. (Up to 4th floor completed)

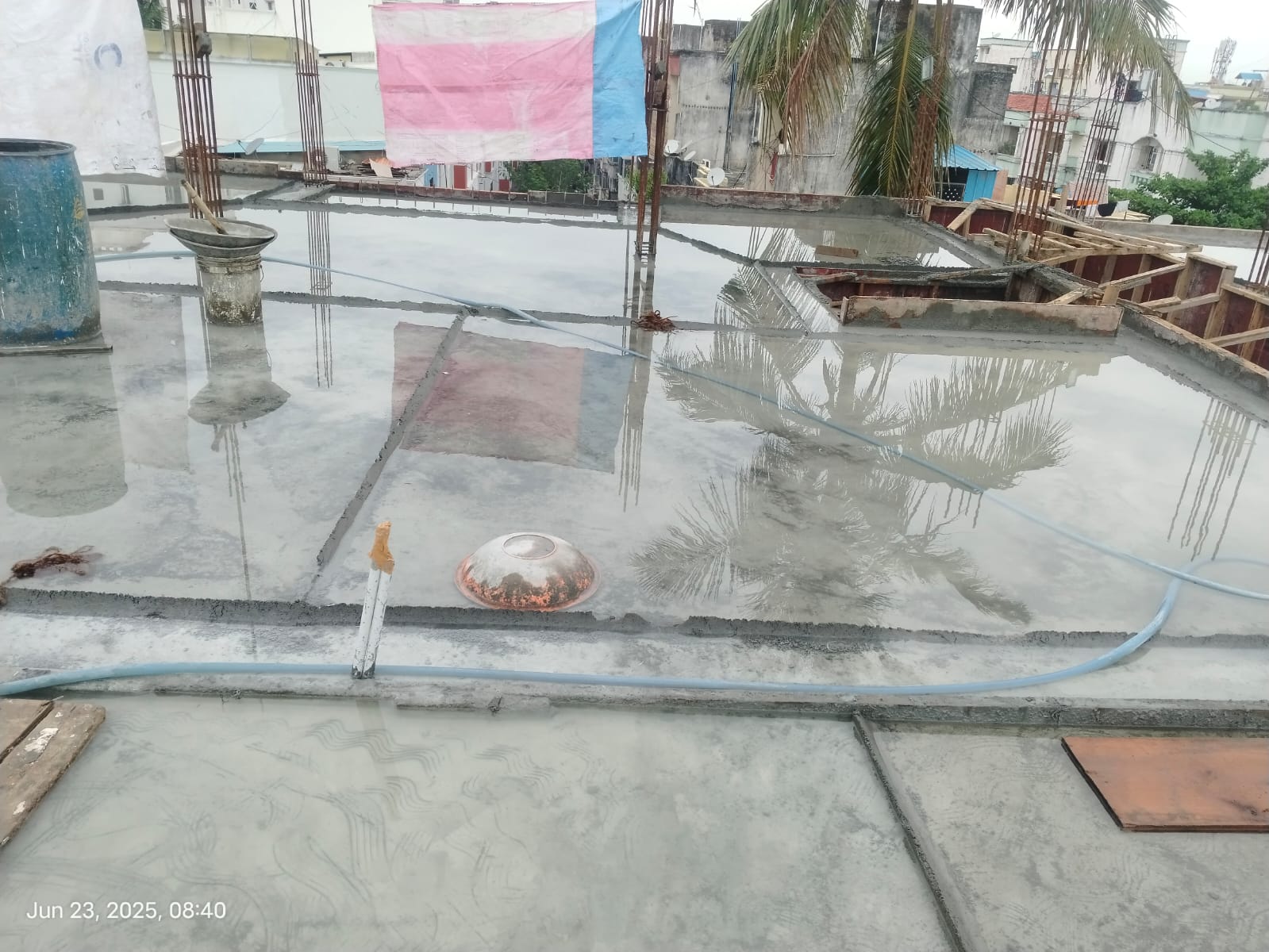

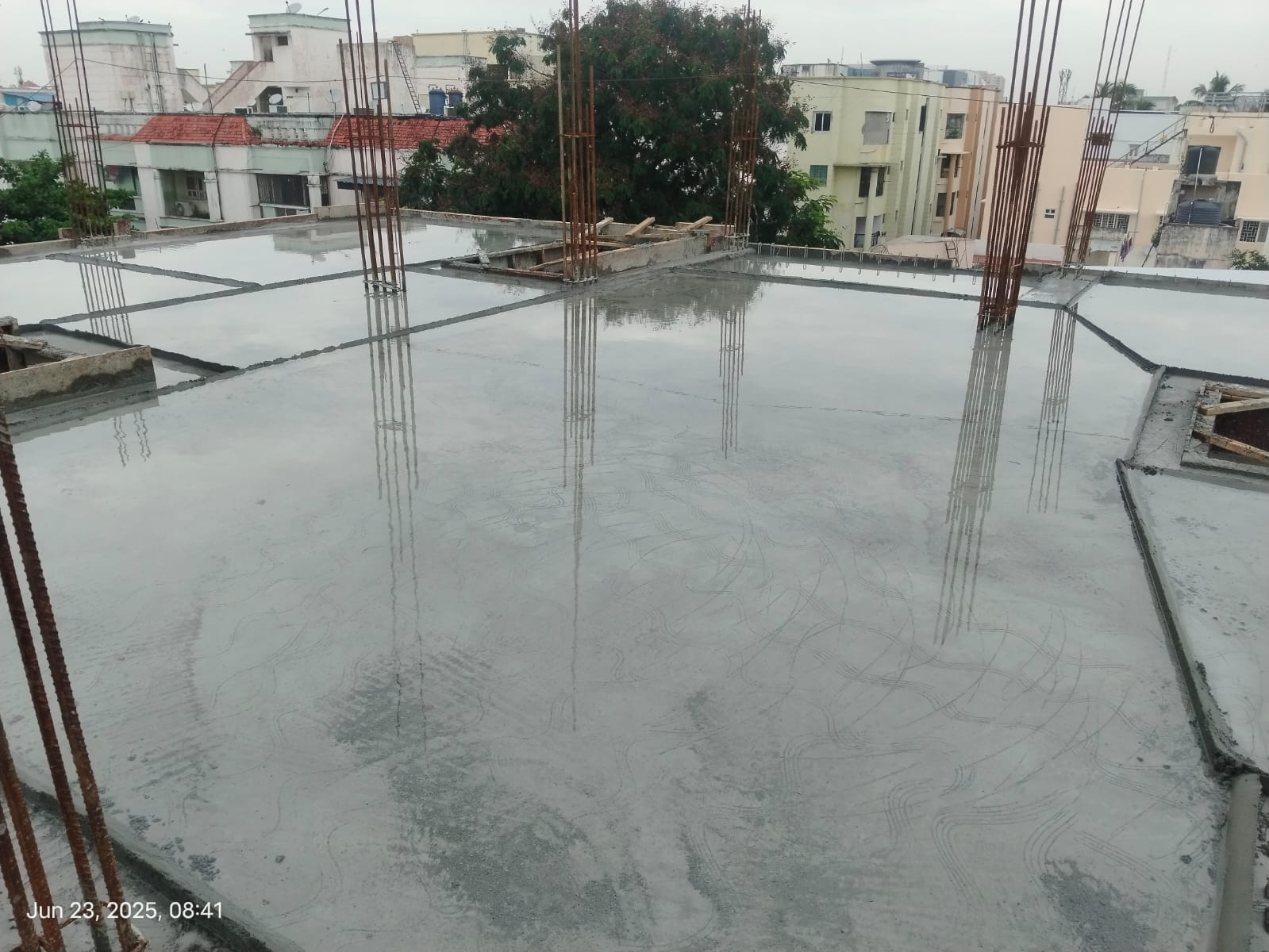

  • Main flooring tiles work is in progress. (Upto 4th floor completed, 5th floor 90% completed).
  • Paving block work is in progress.(40% completed)
  • Elevation terracottajalli work is in progress.(50% completed)
  • External chamber work is in progress.(90% completed)
  • Set back earth filling work is in progress.(75% completed)
  • Outer GSB filling work is in progress.(70% completed)
  • UPVC window fixing work is in progress.(Upto 4th floor completed,5th floor progress 80% completed)
