Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Prema Saraswathi

Mylapore

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV

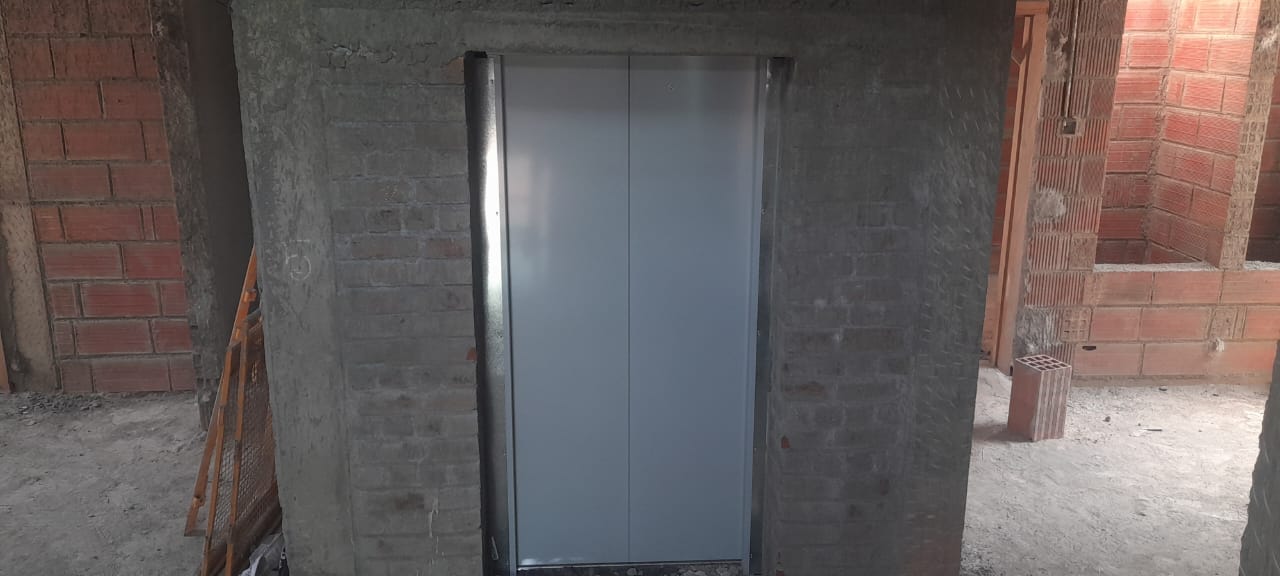

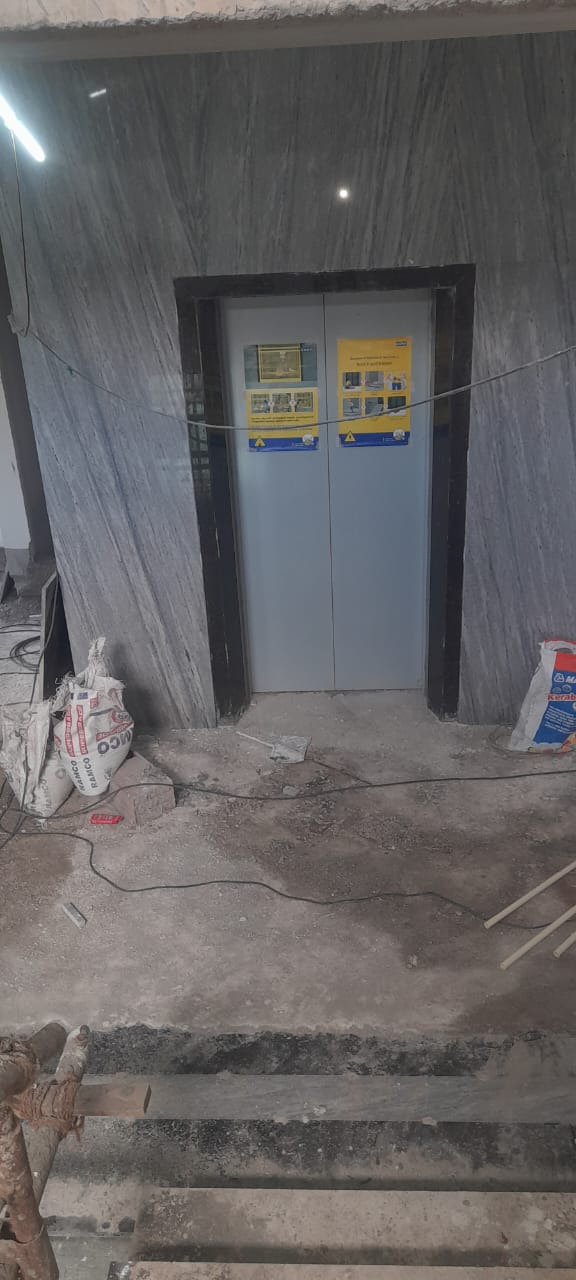

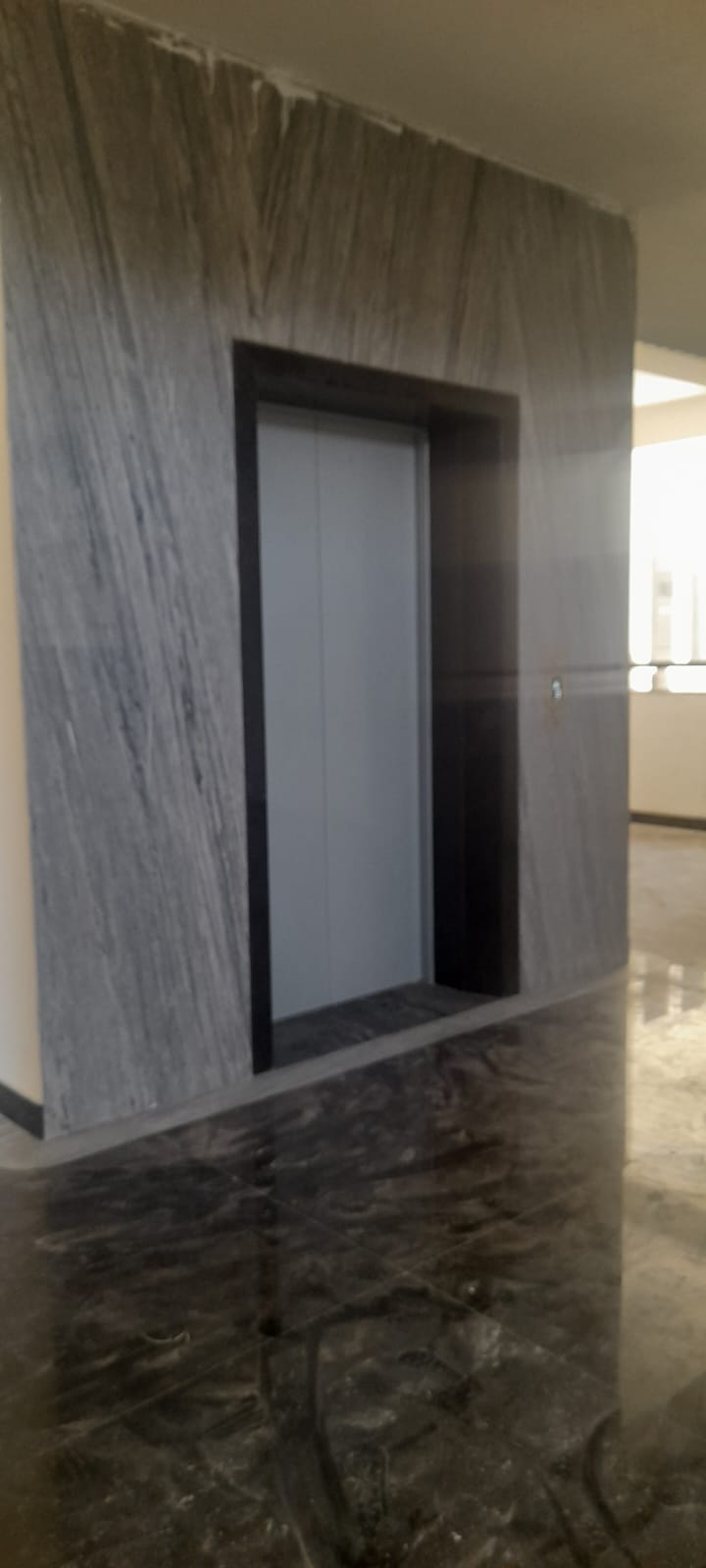

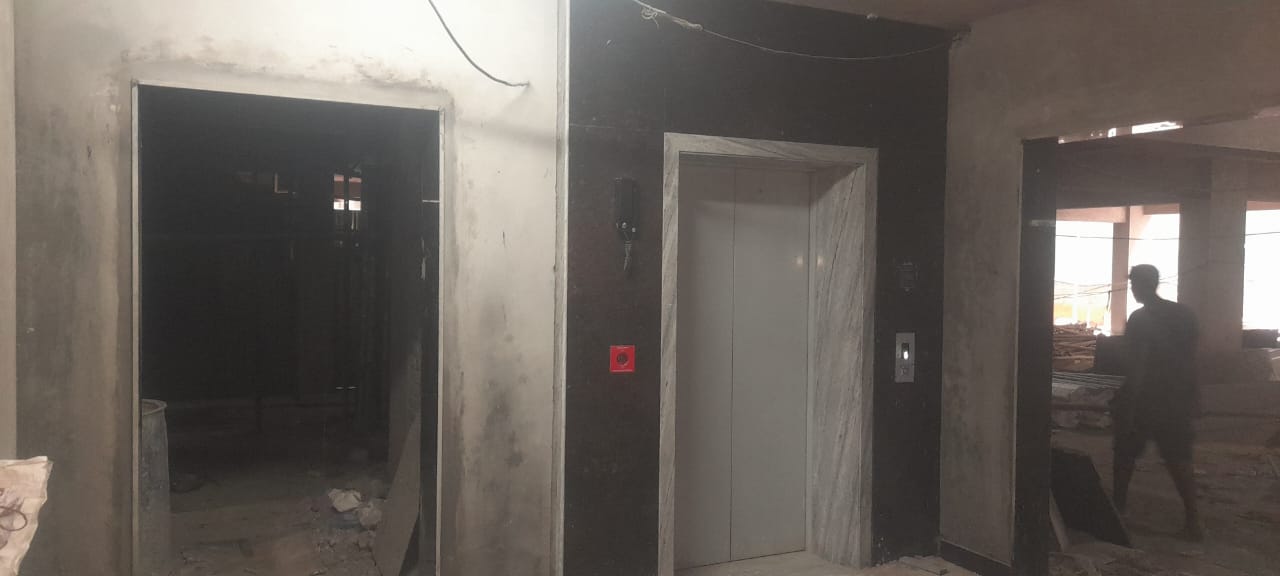

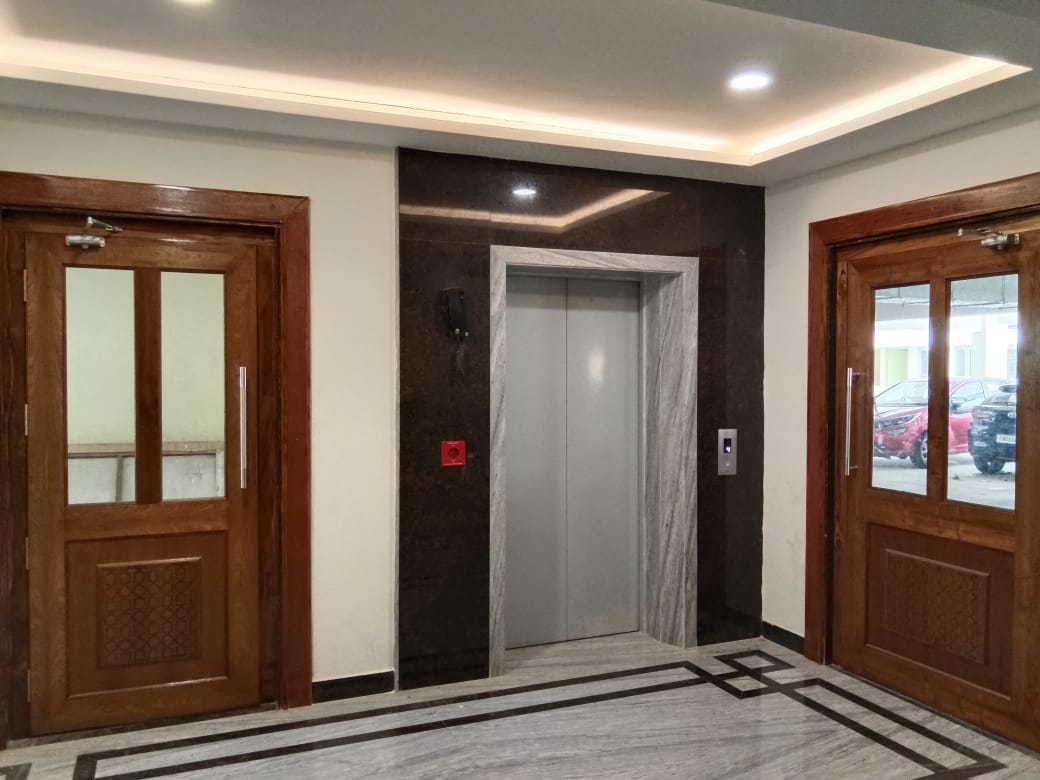

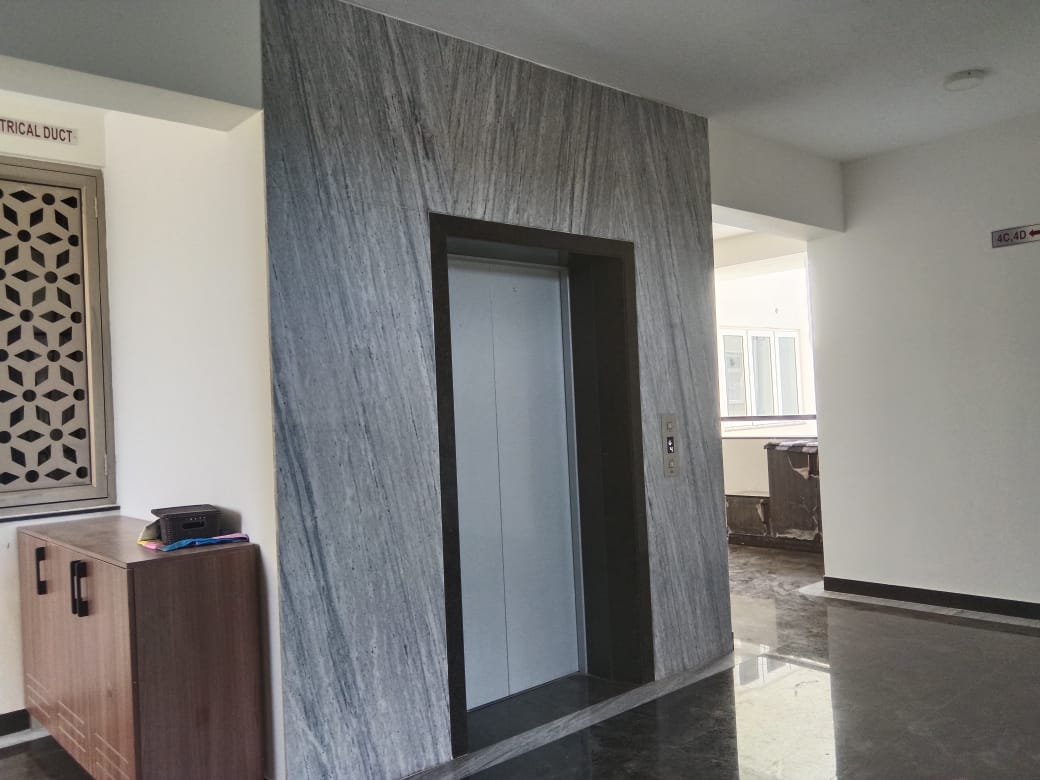

Elevators
Lobby
Rain Water Harvesting

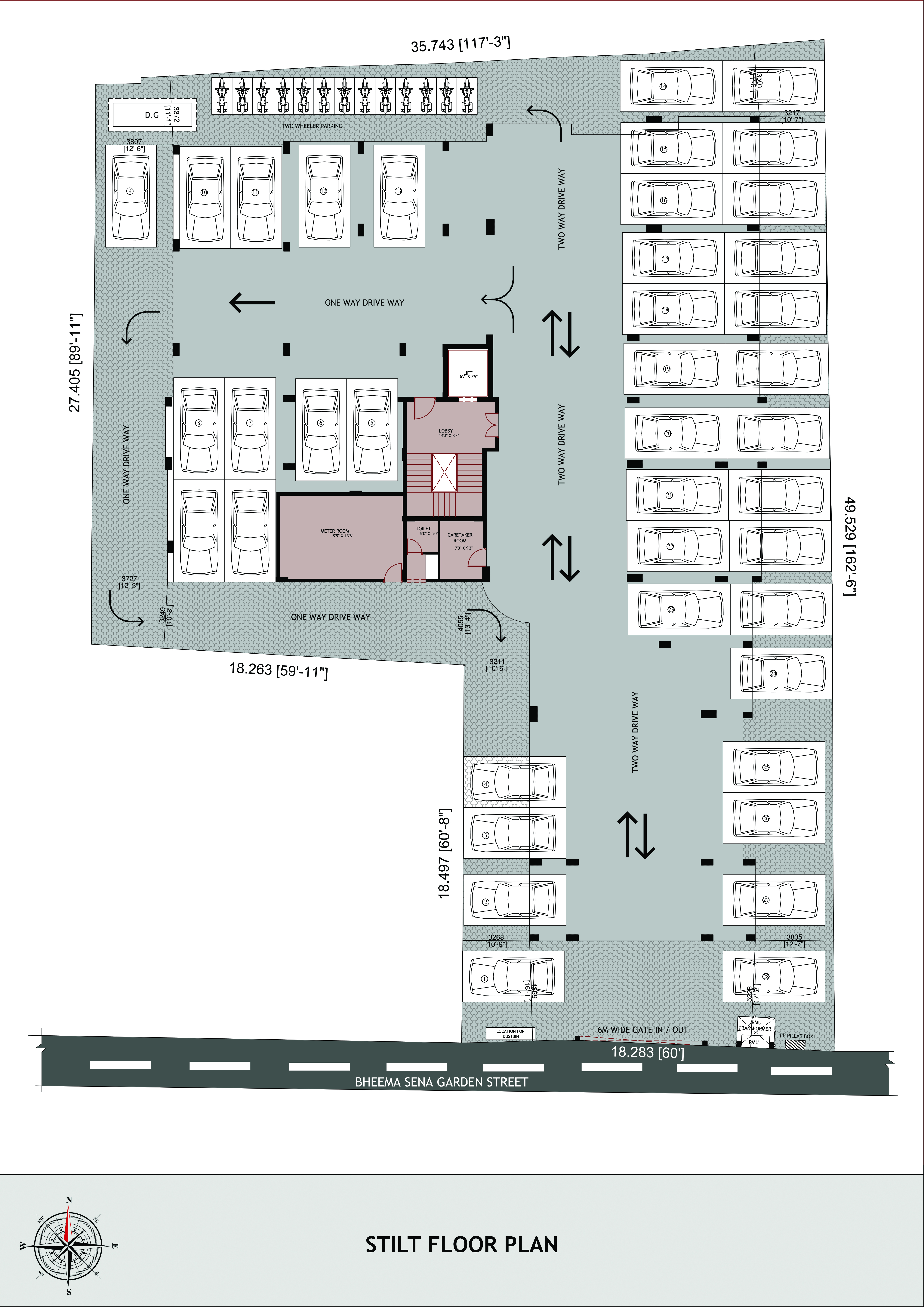

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
1C 1 3BHK + 3T 1699 West Available
2B 2 3BHK + 3T 1671 East Available
2C 2 3BHK + 3T 1699 West Available
1B 1 3BHK + 3T 1671 East Available

Approvals

Planning Permit No:

OL- PP / NHRB / 0493 / 2024

Date of Permit:

2024-08-14

Building Permission No:

CEBA / WDCN09 / 00424 / 2024

Date of Permit:

2024-08-19

TNRERA:

TN / 29 / Building / 0008 / 2025

Dated:

2025-01-10

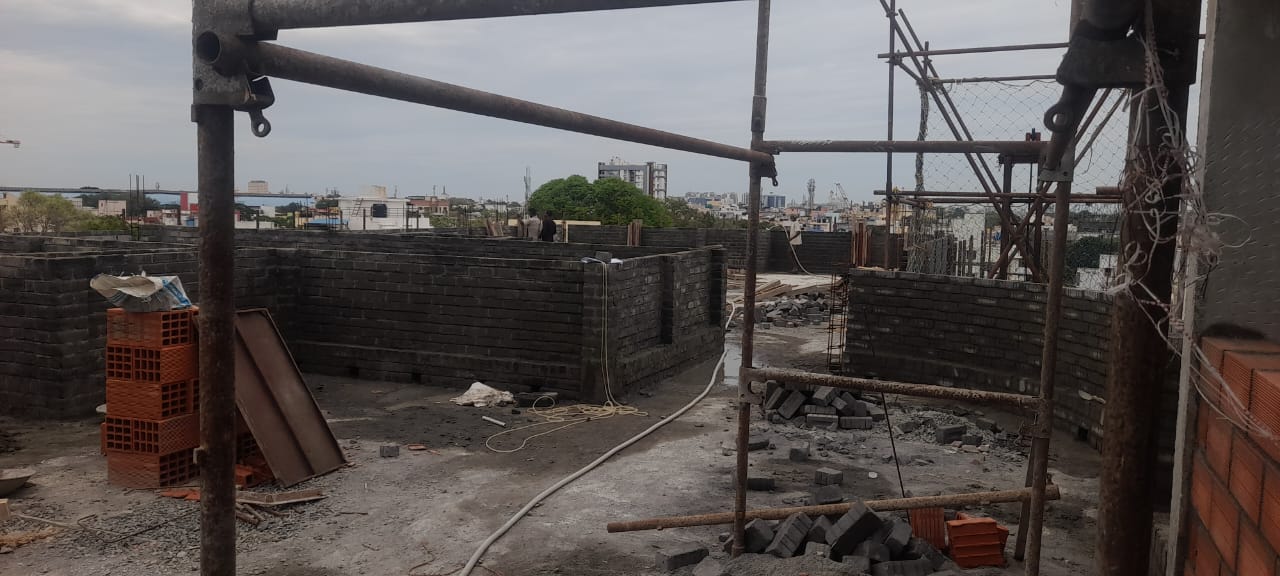

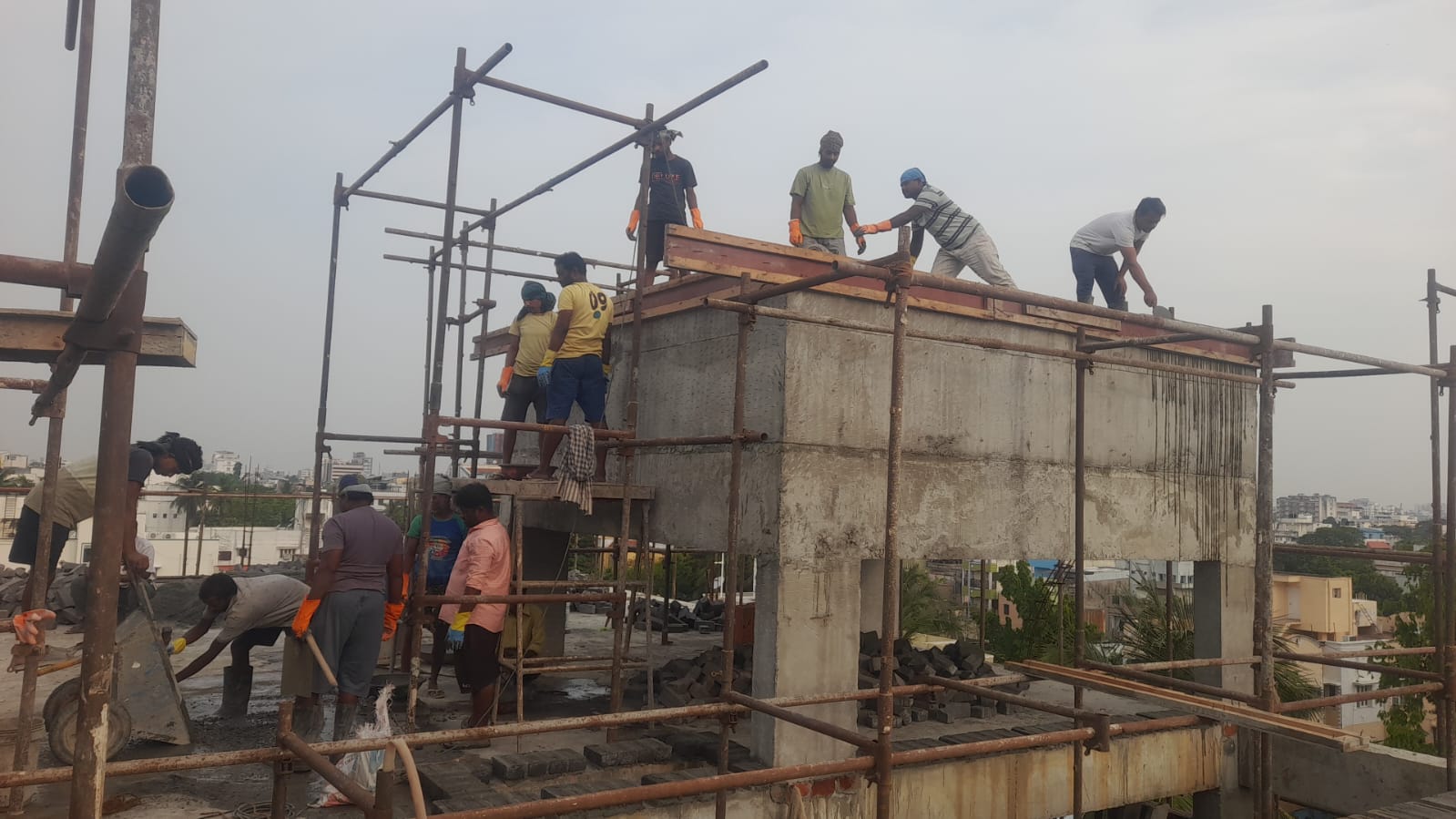

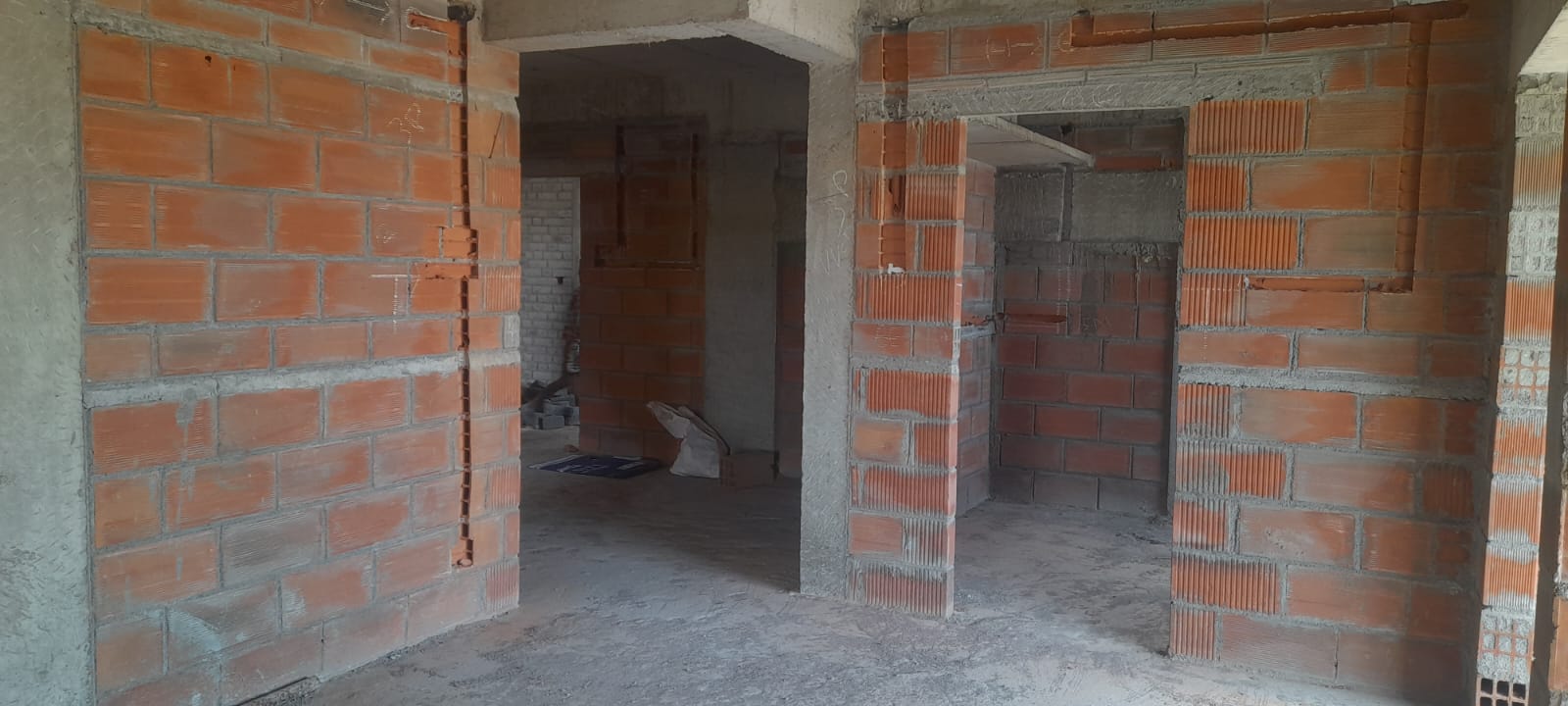

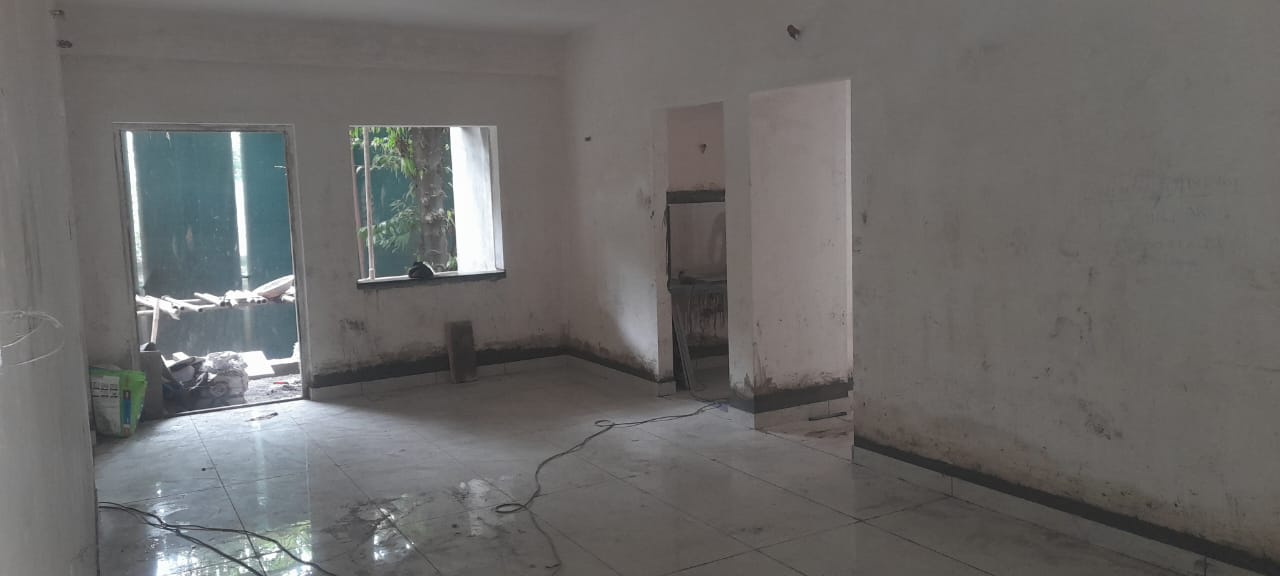

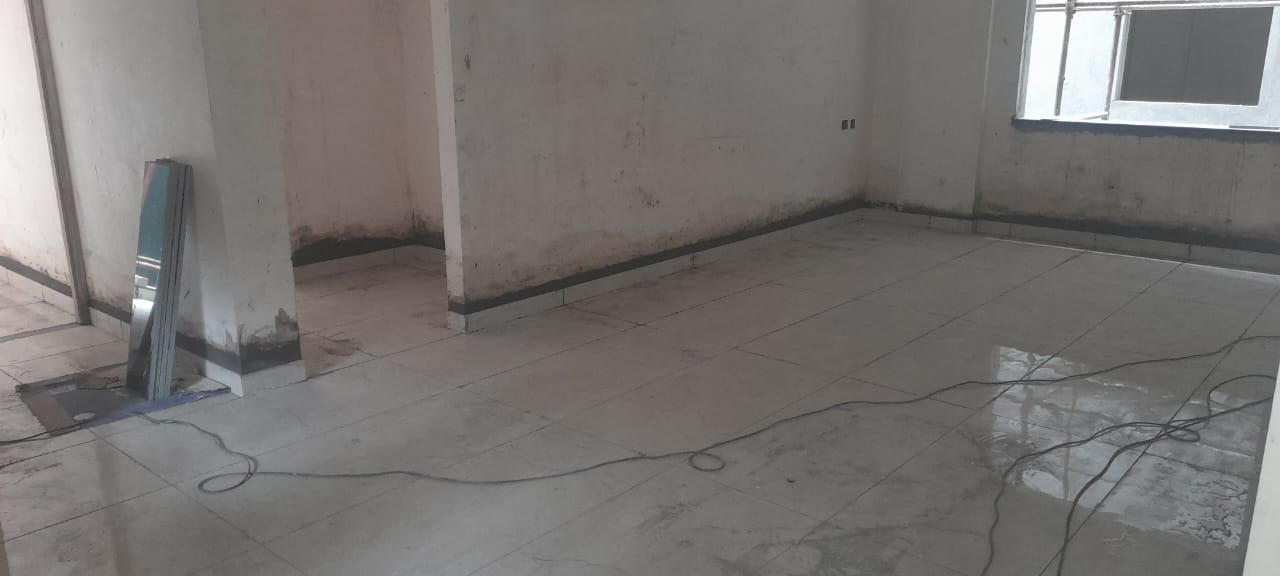

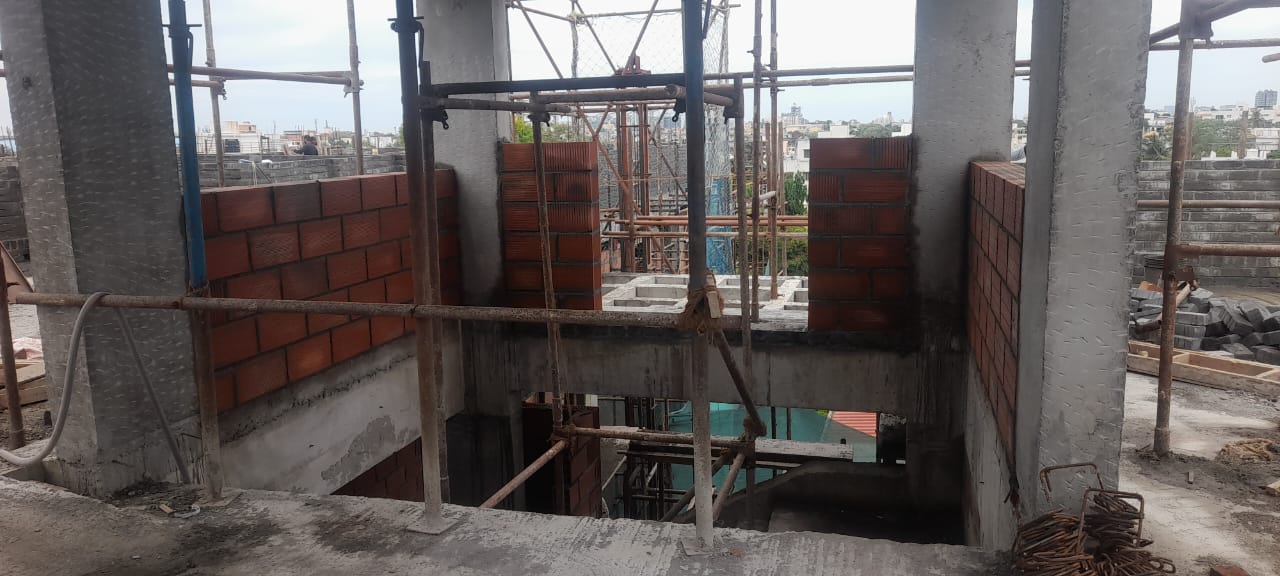

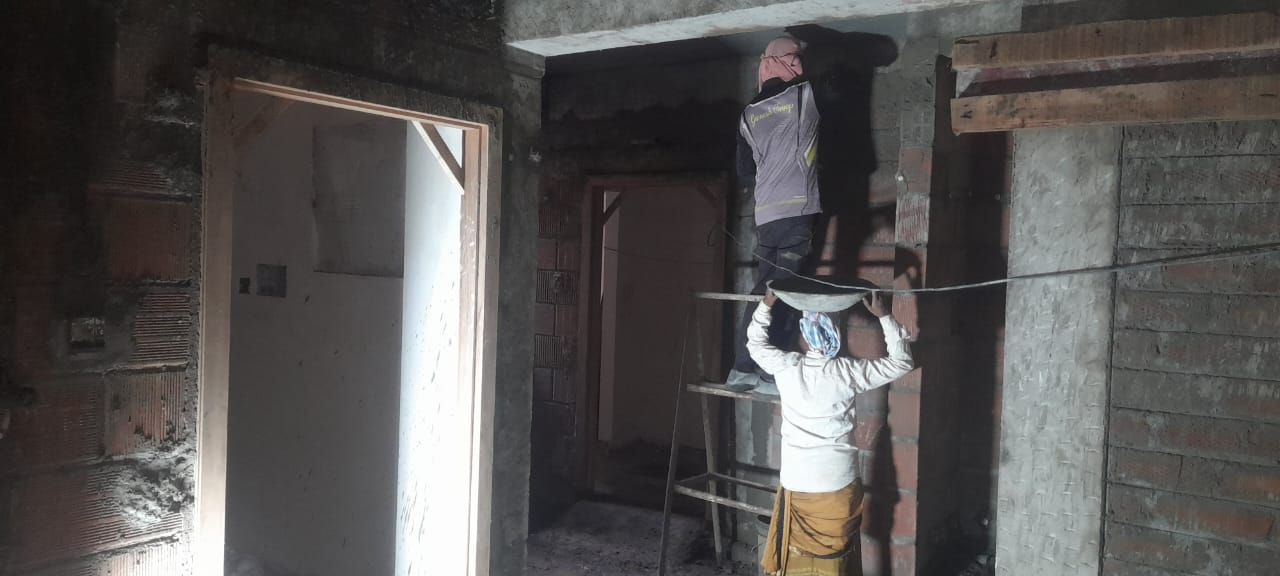

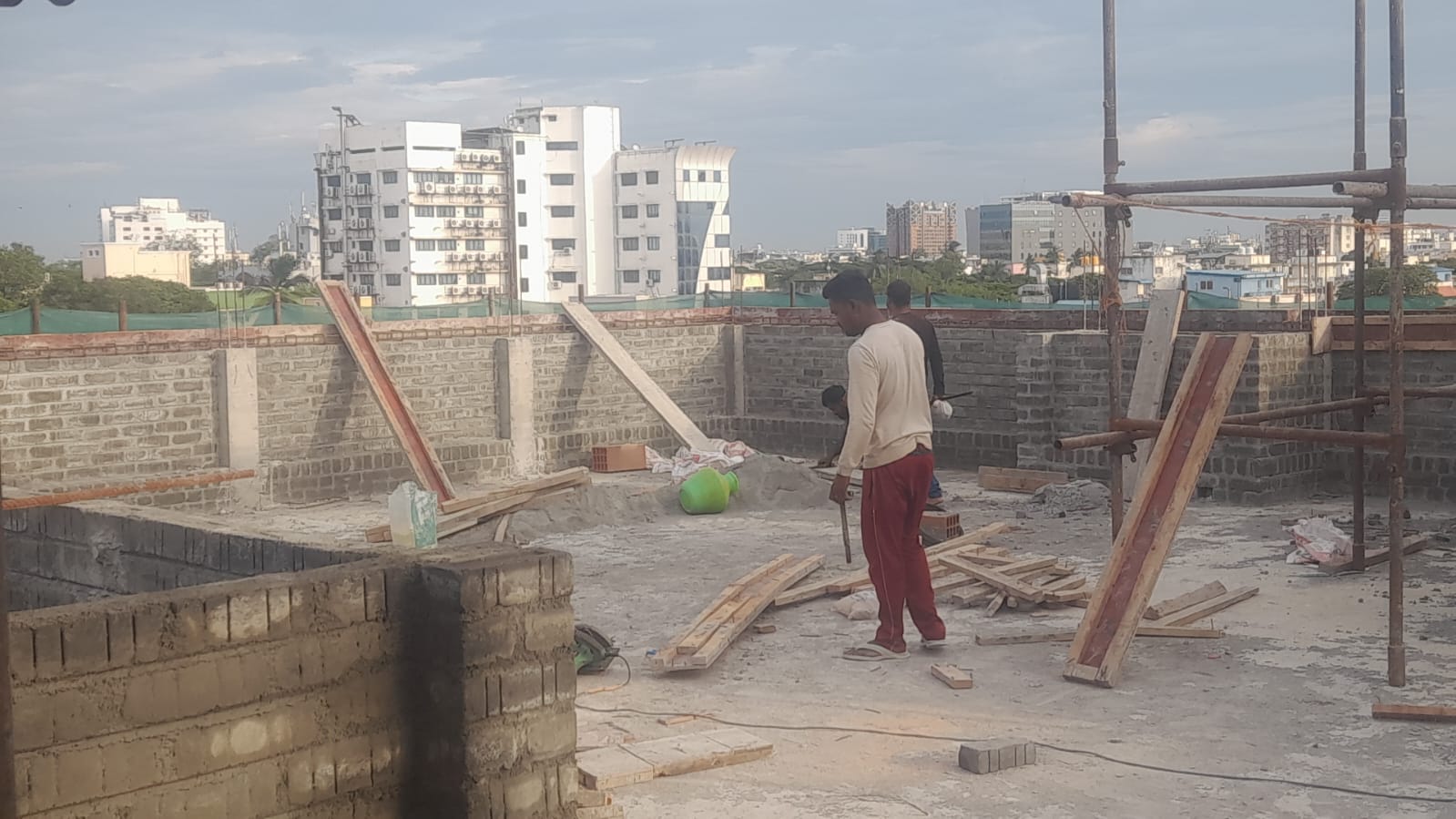

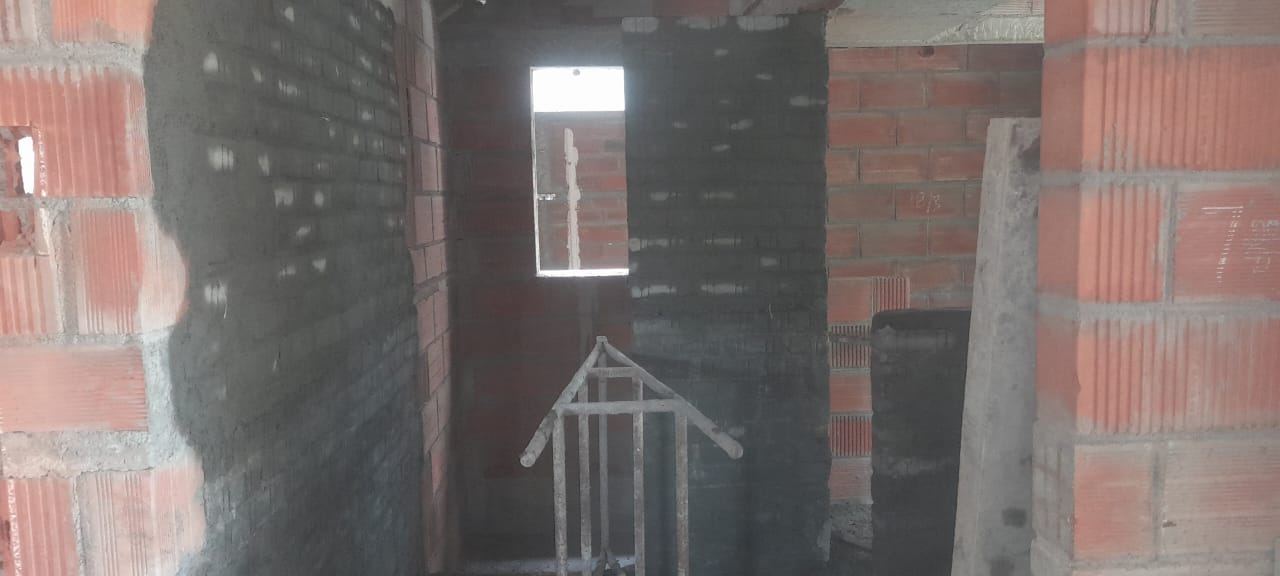

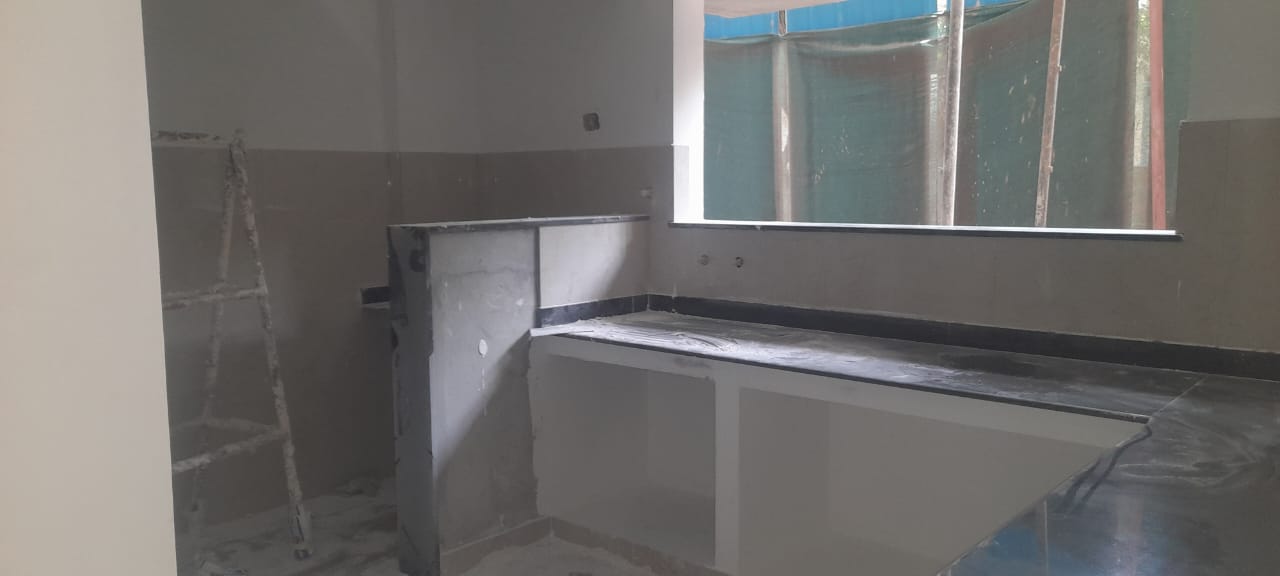

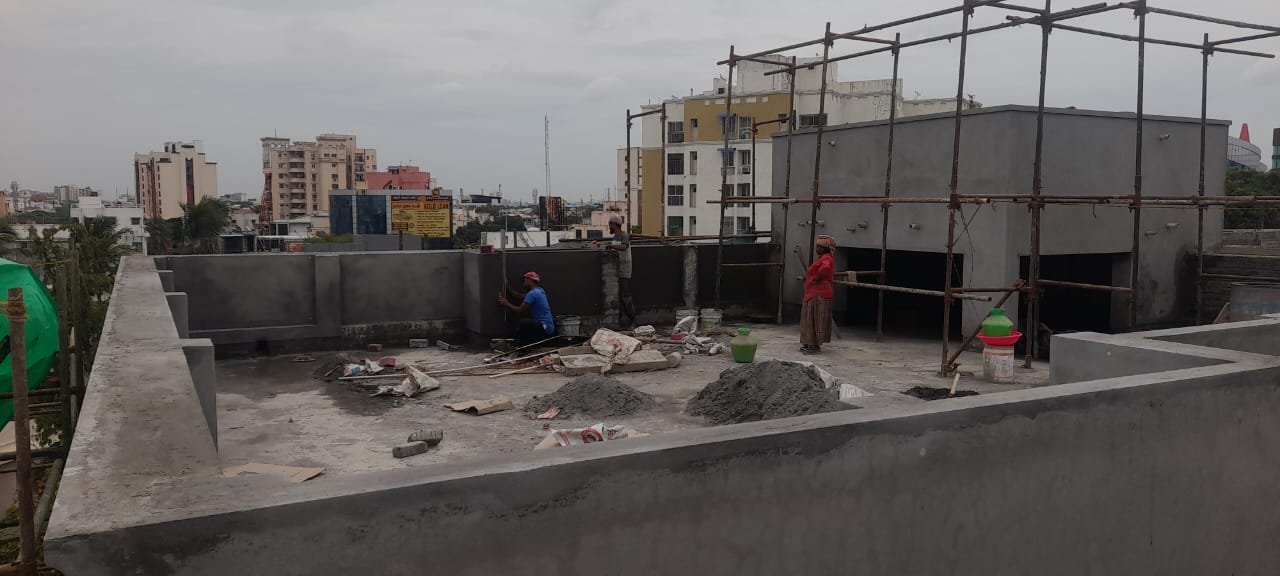

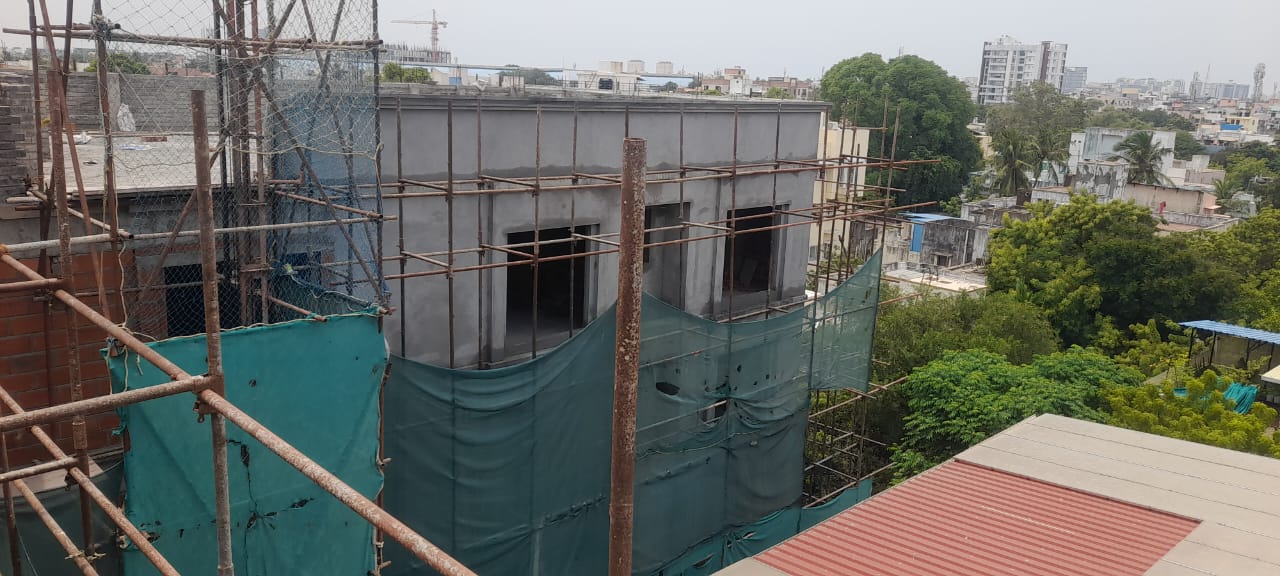

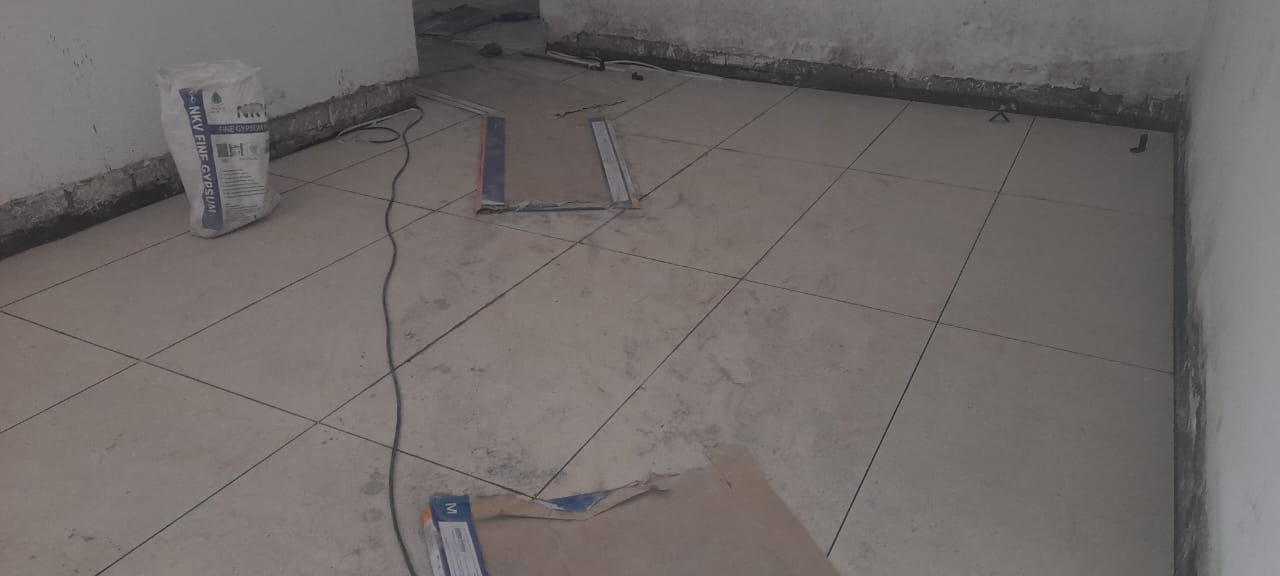

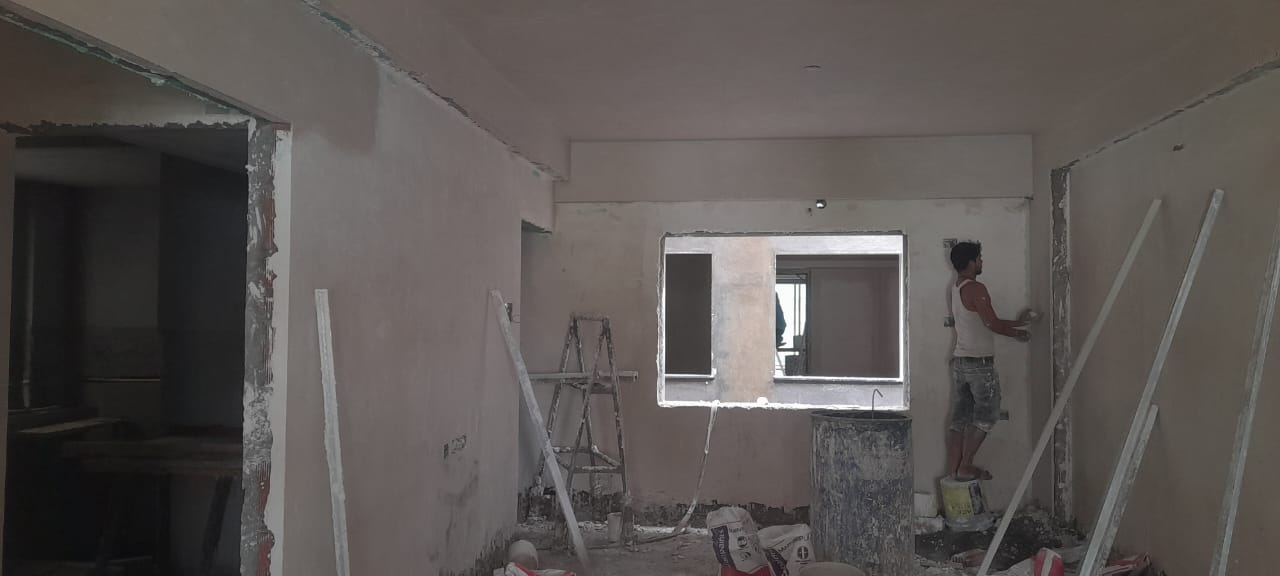

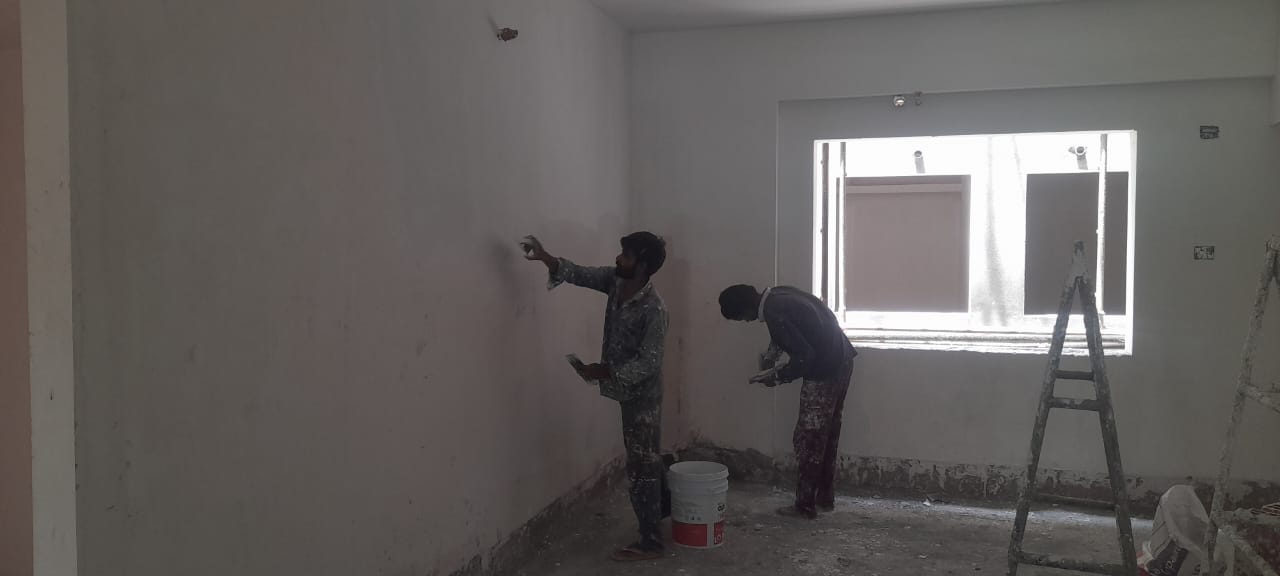

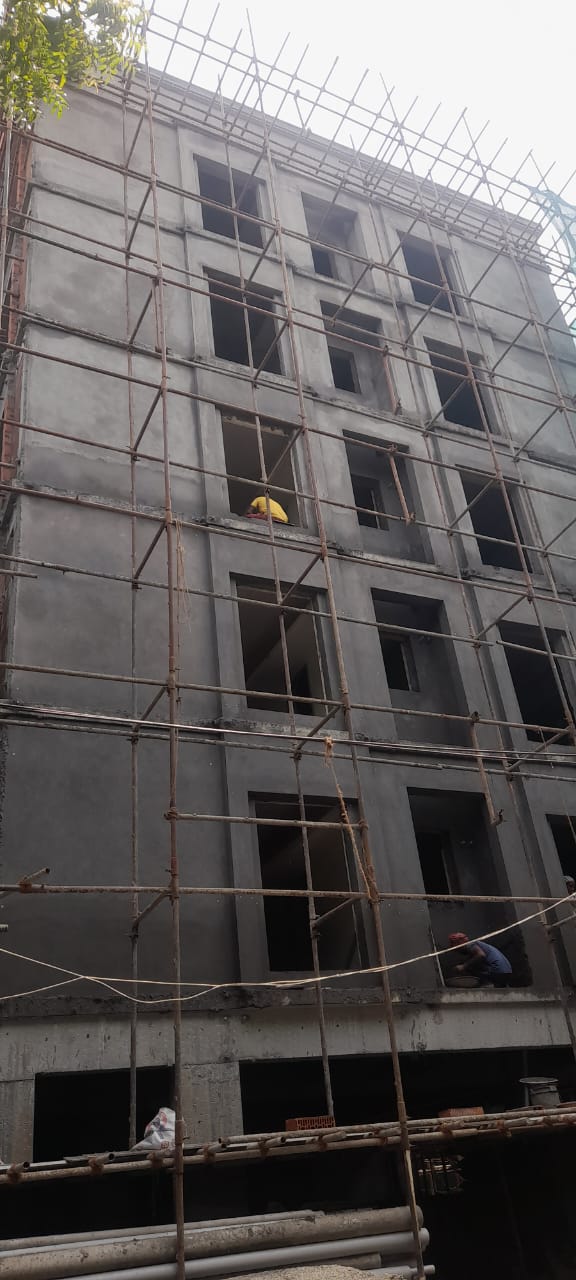

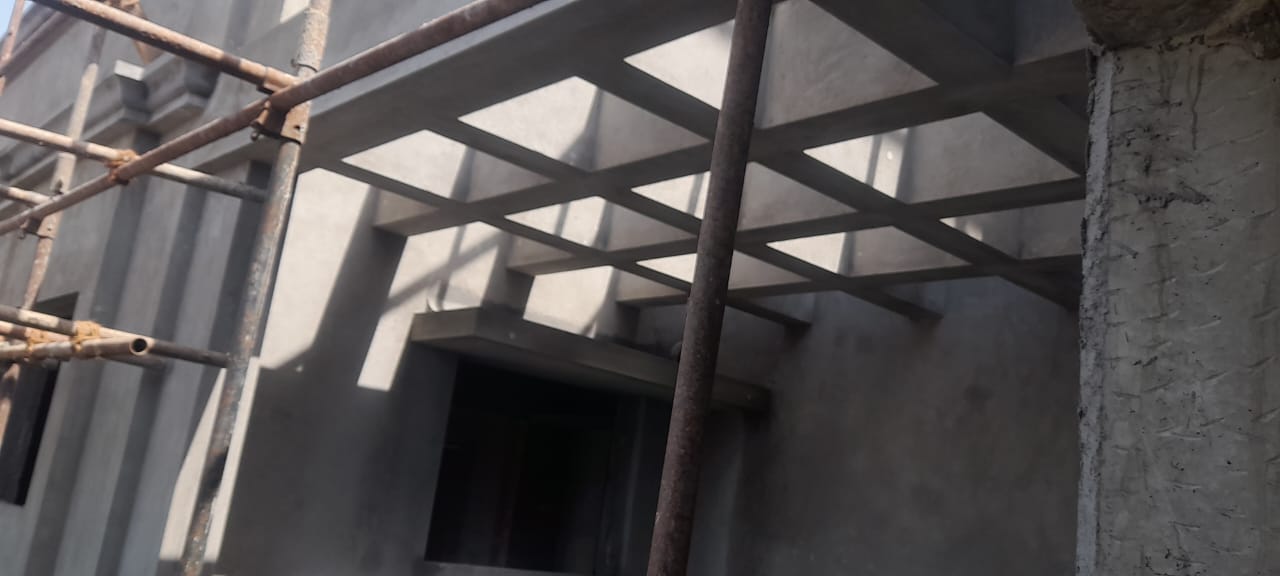

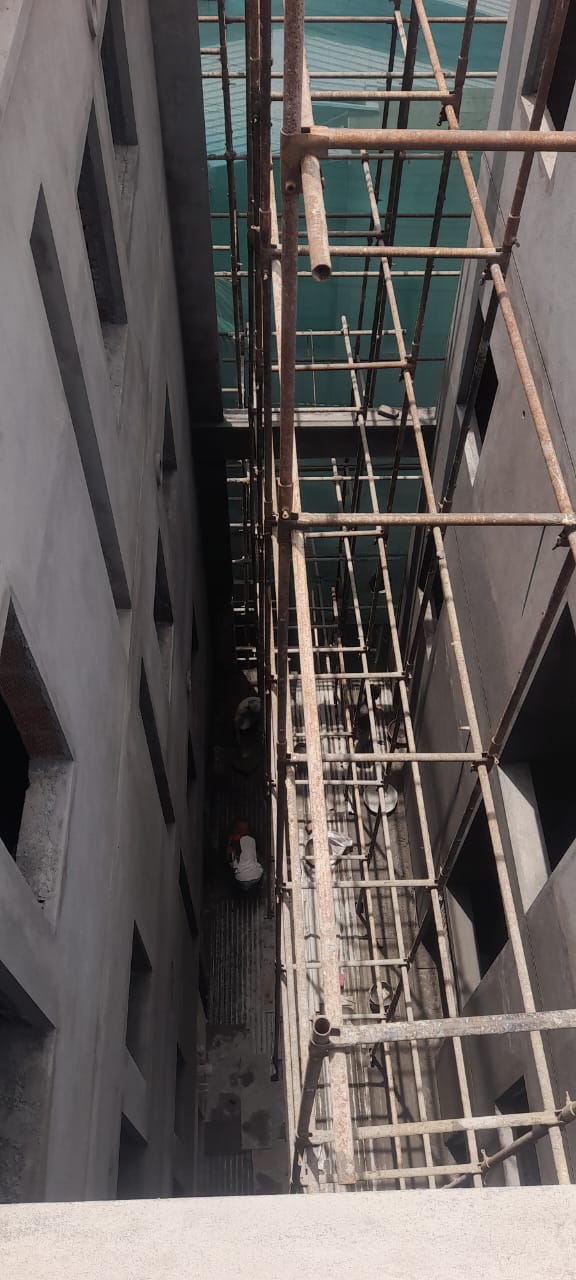

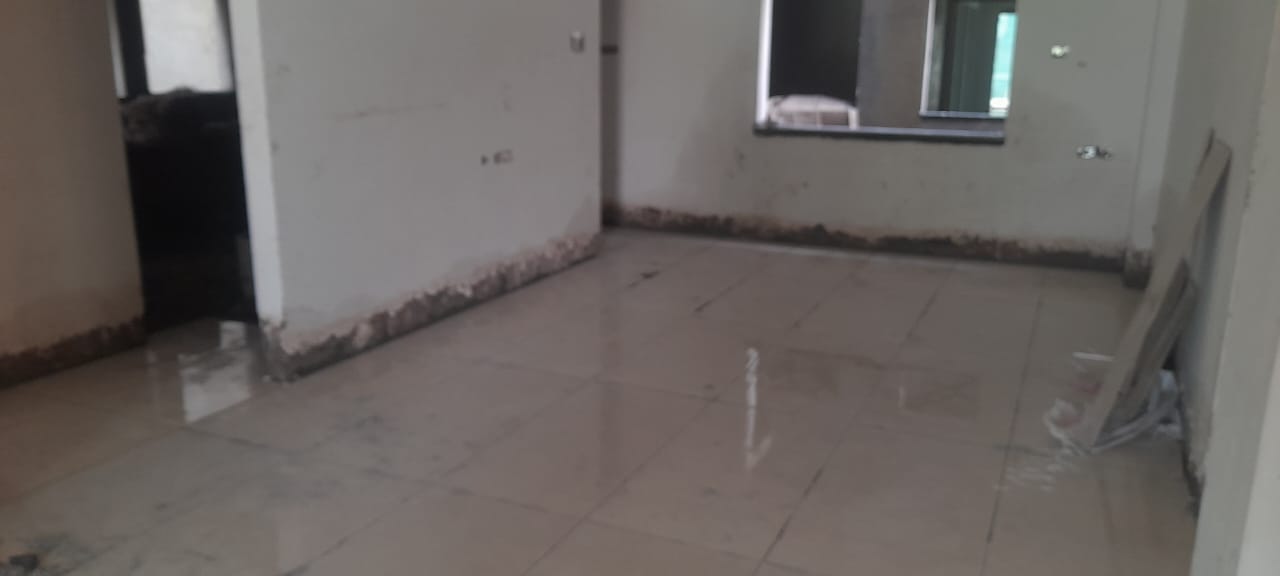

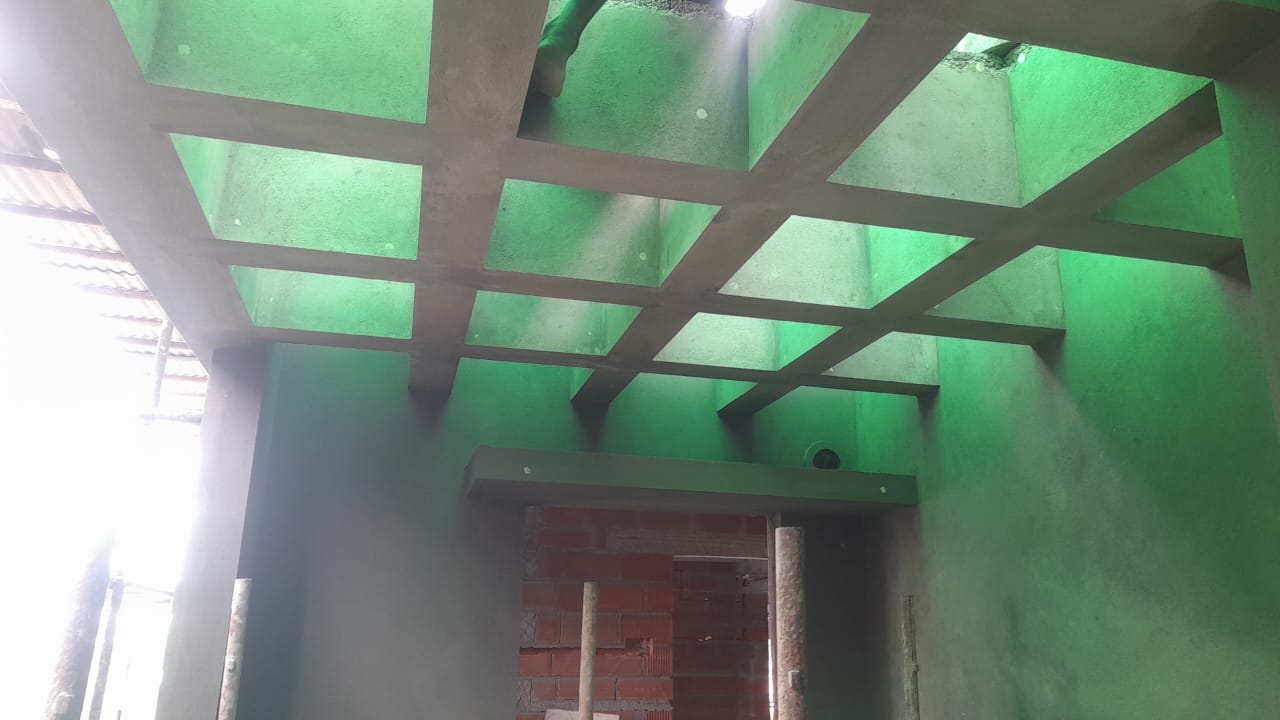

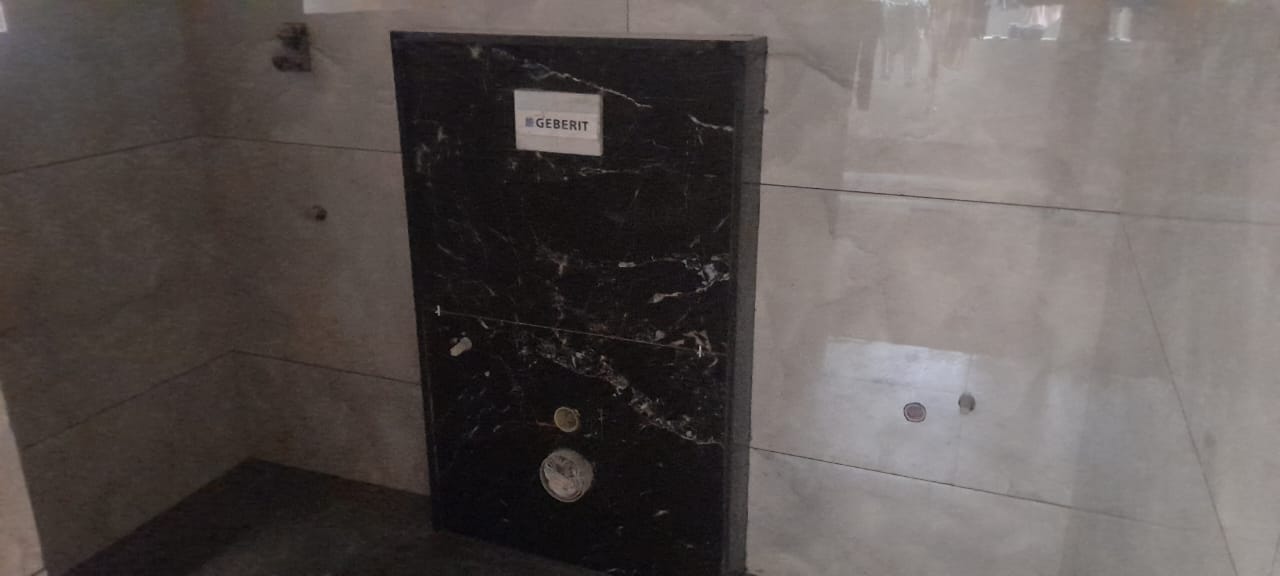

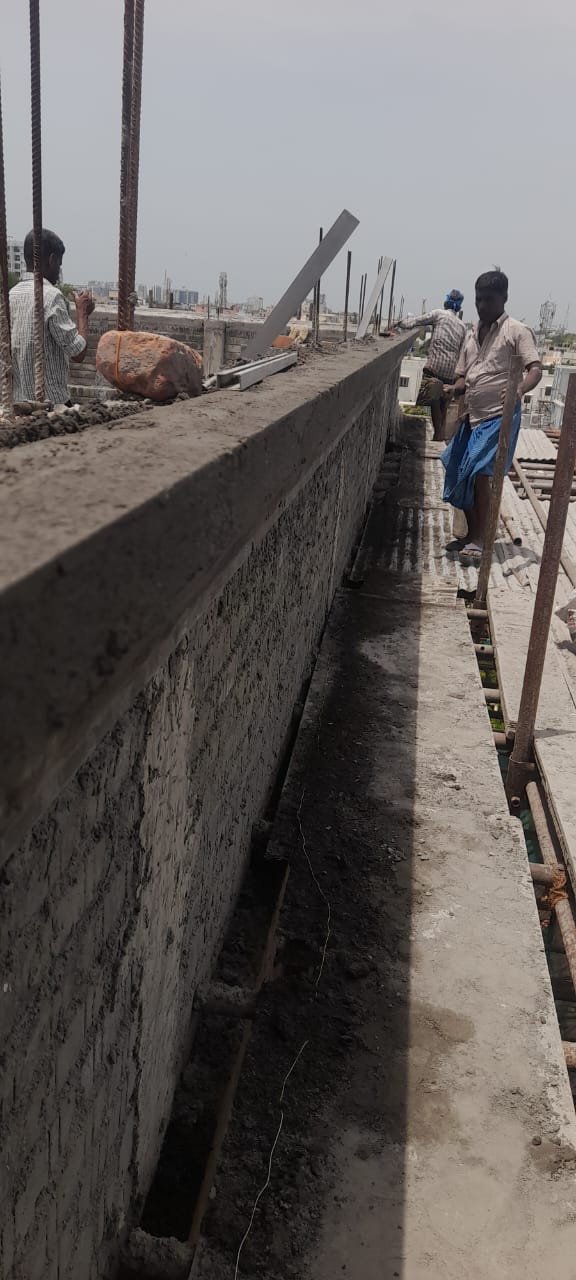

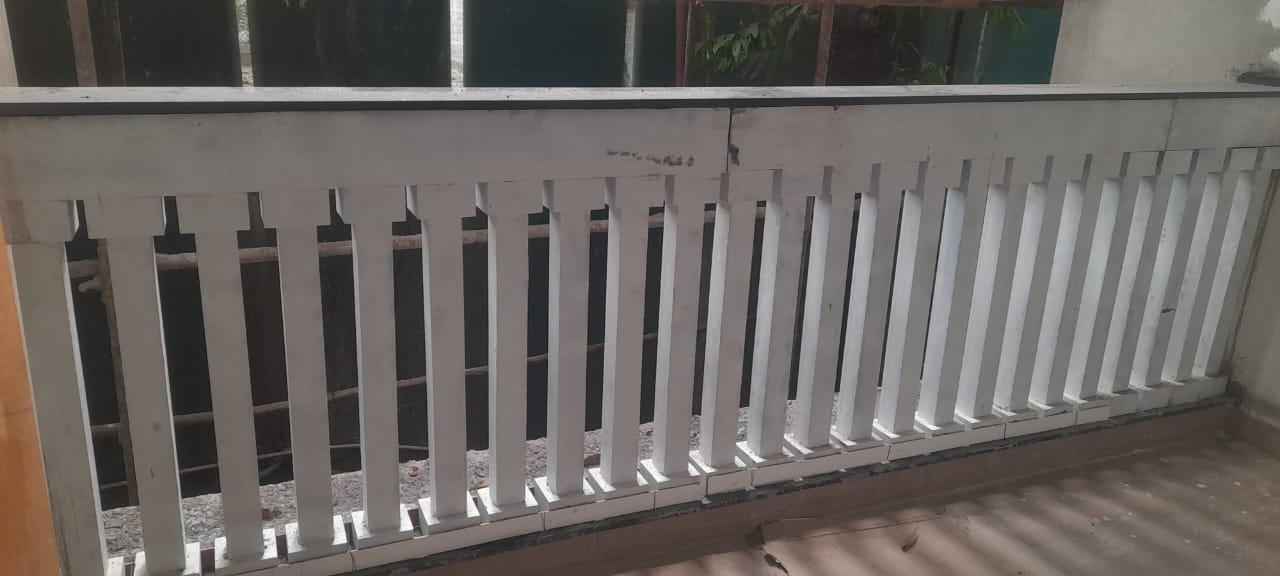

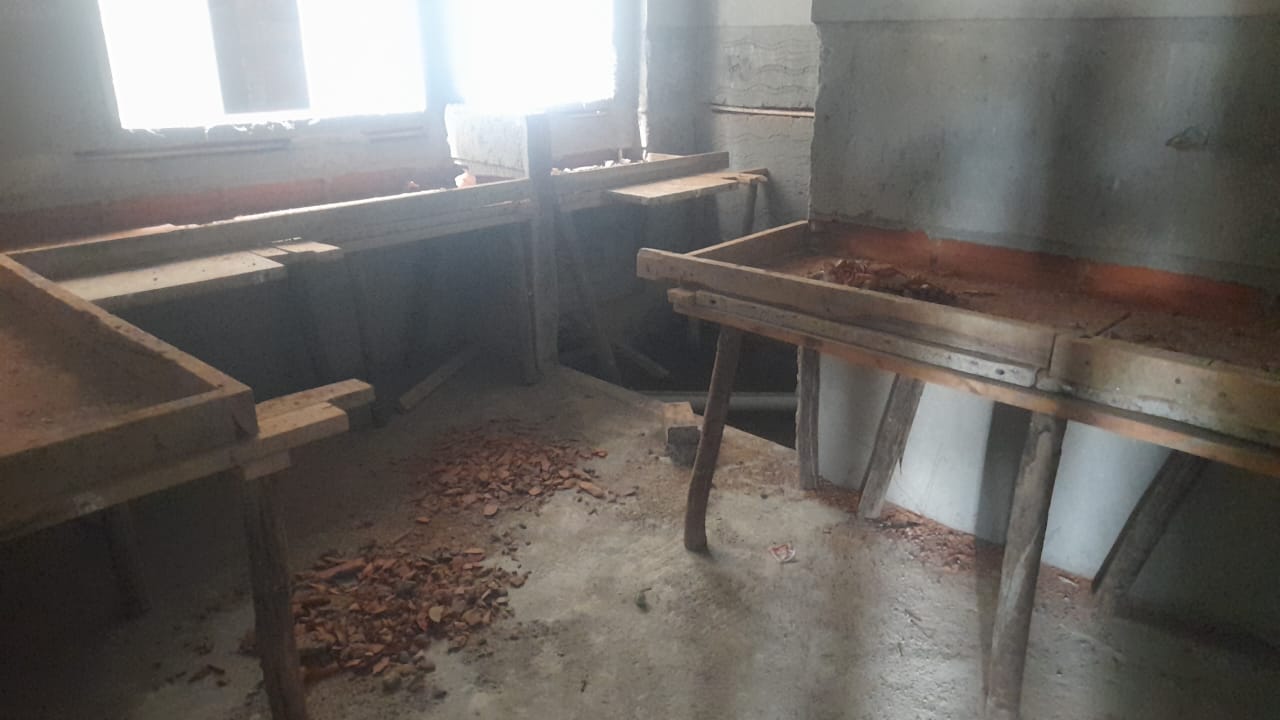

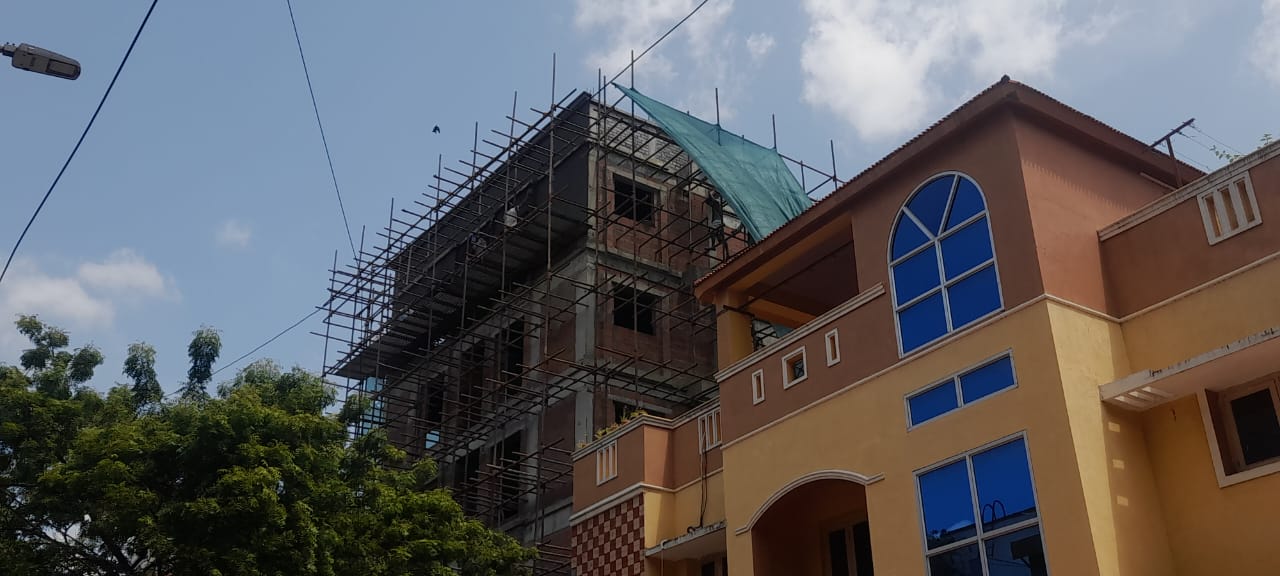

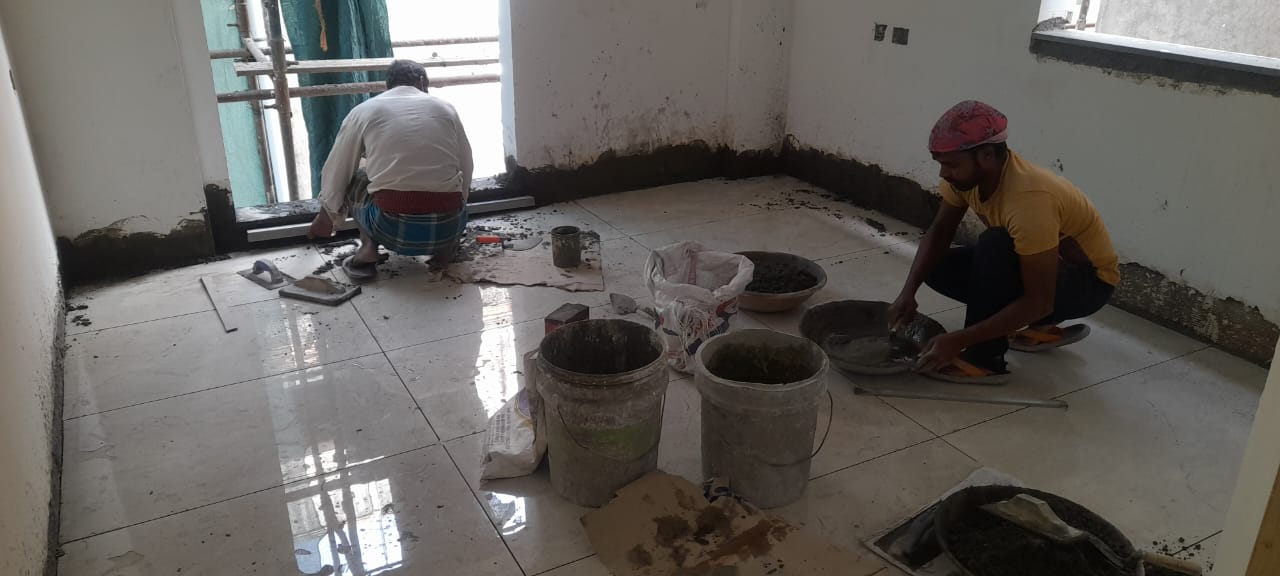

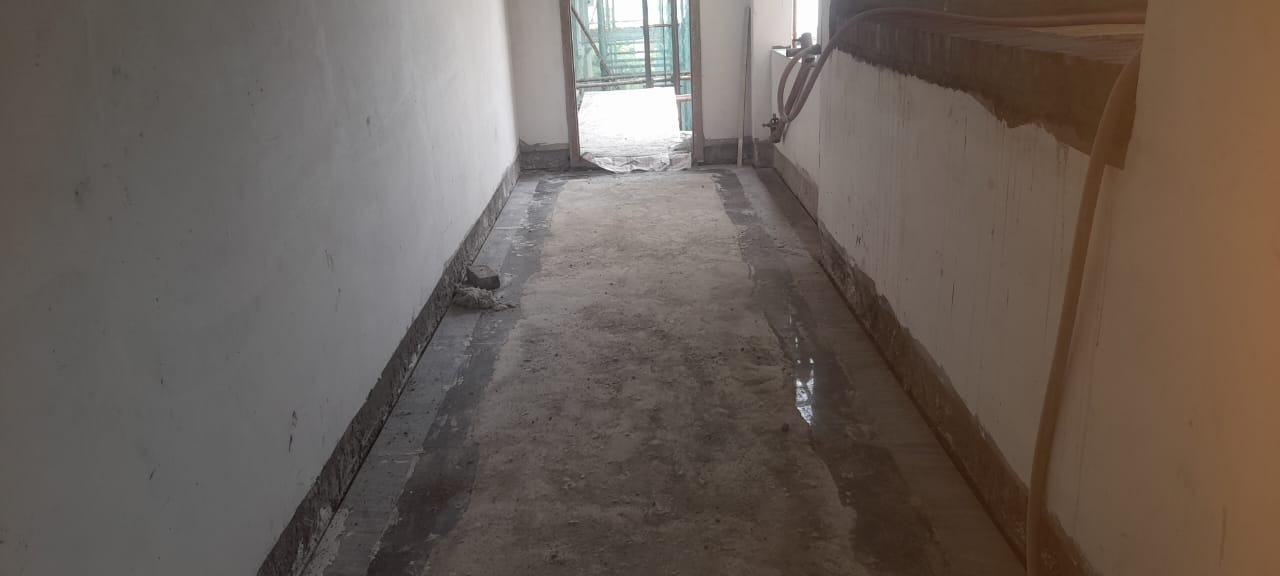

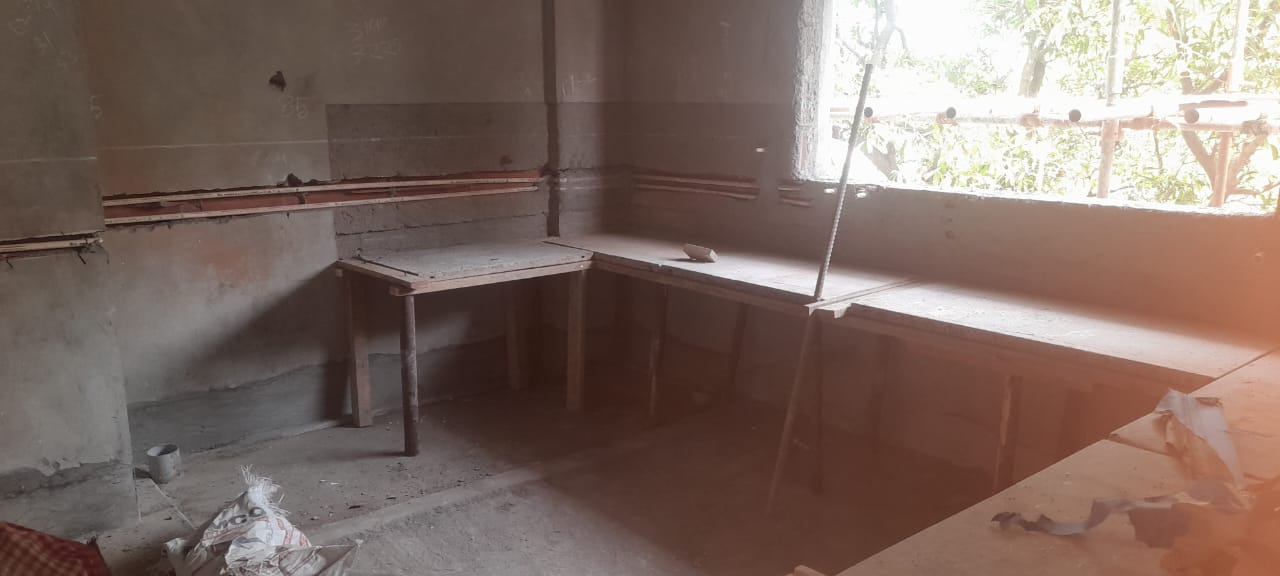

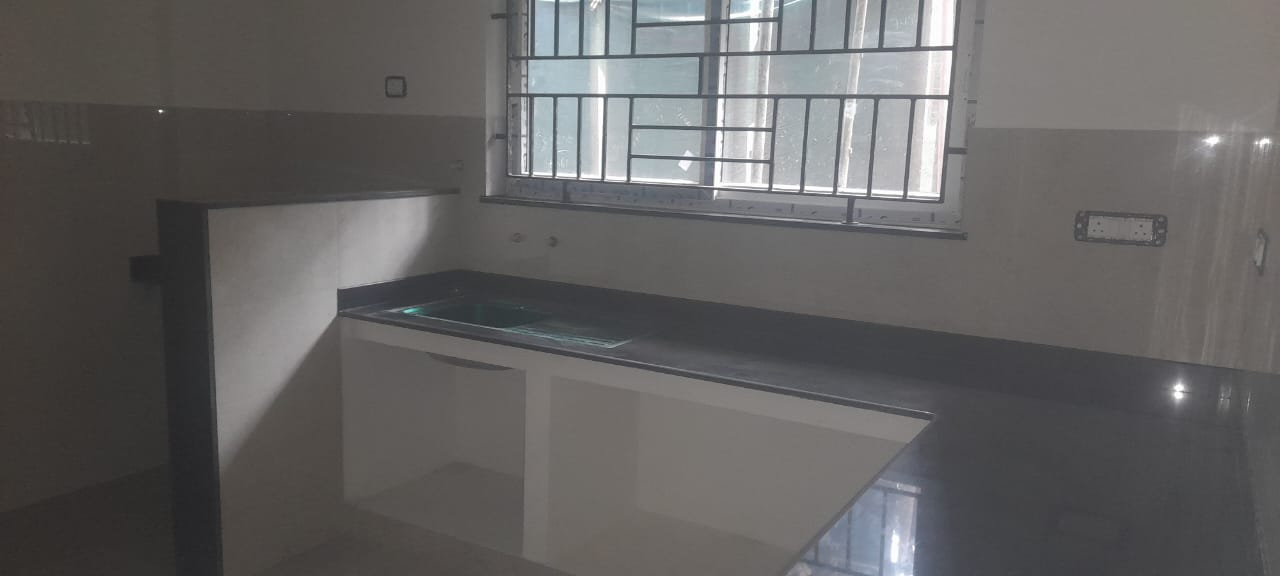

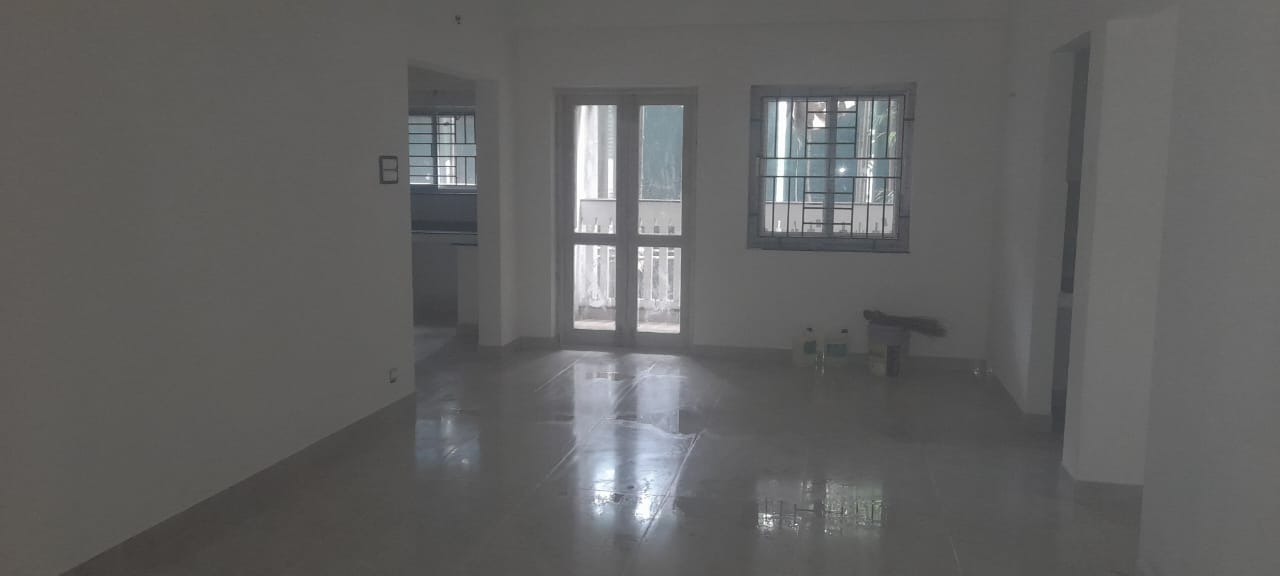

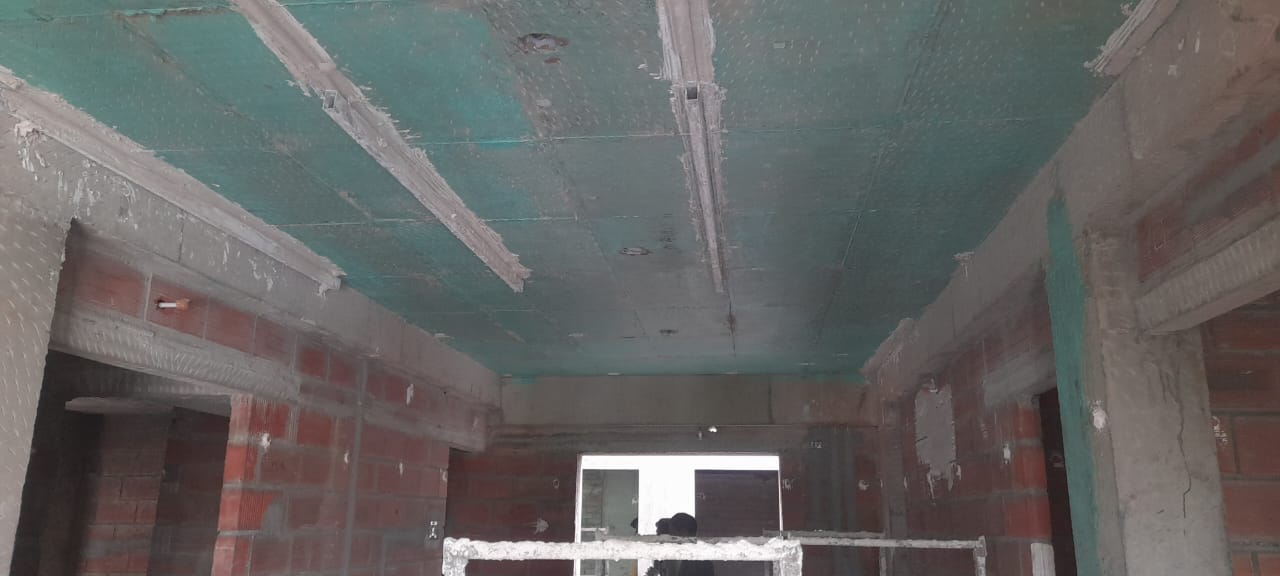

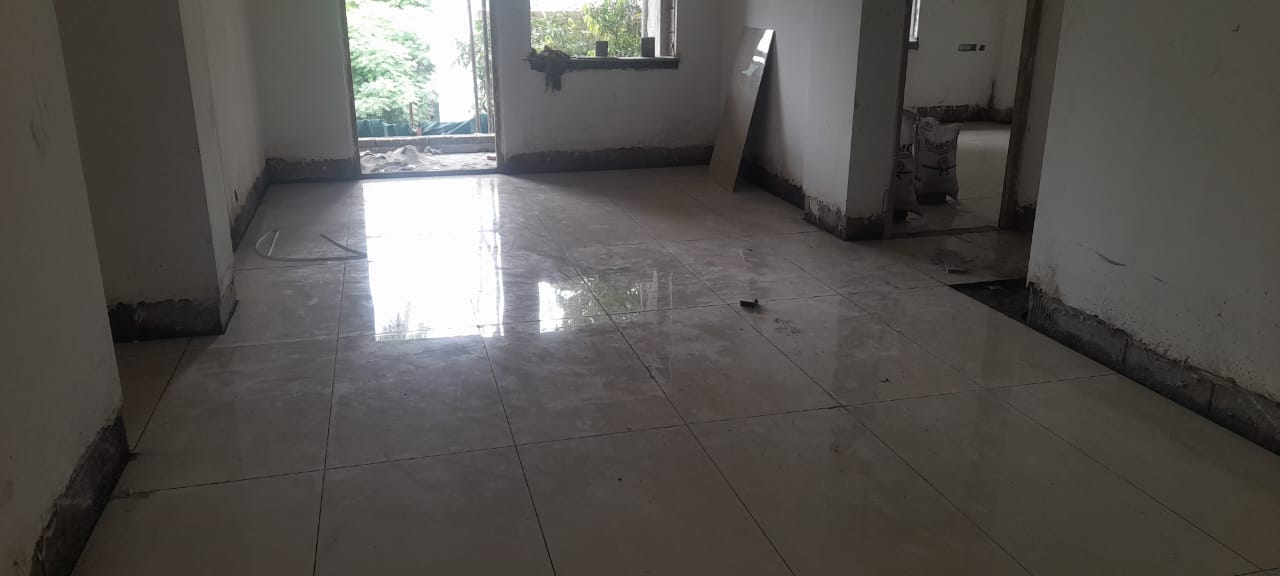

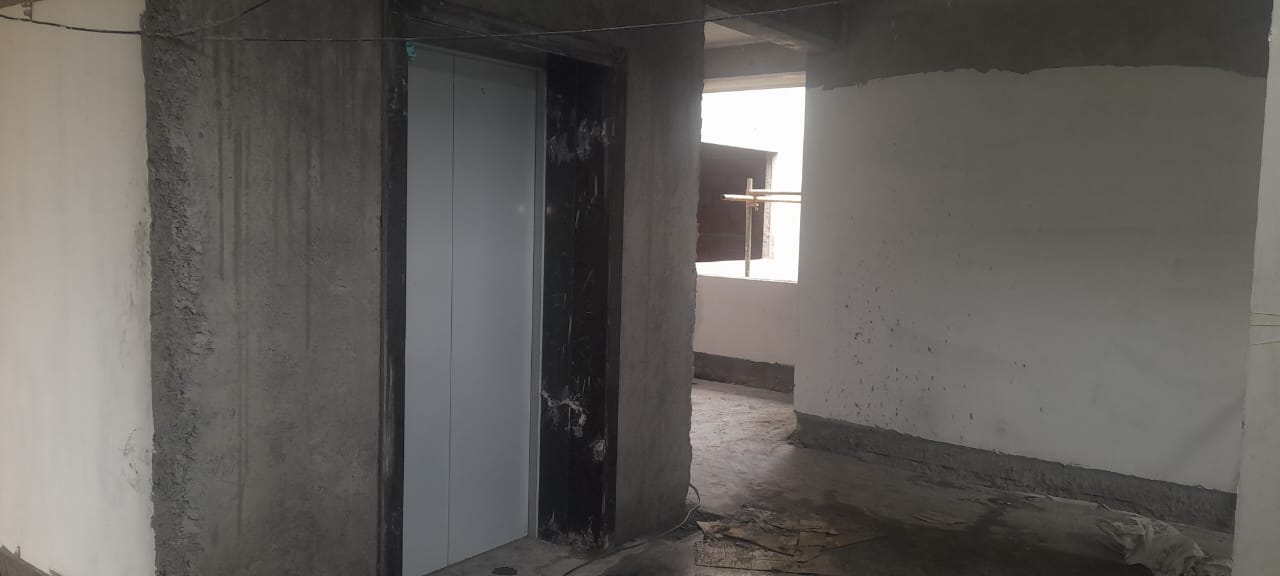

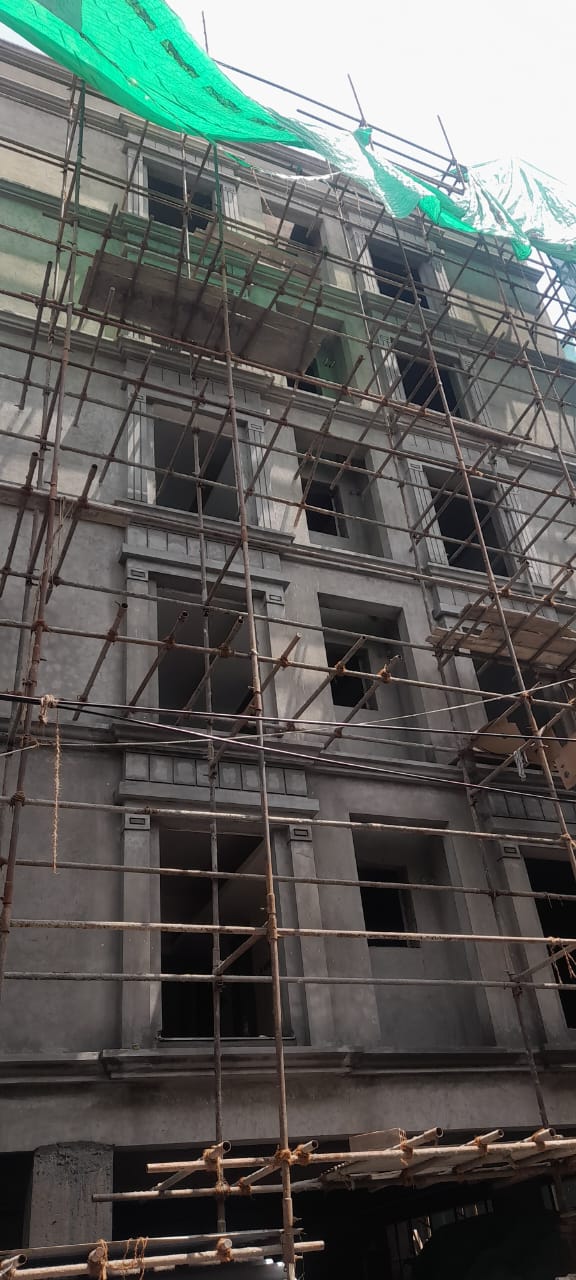

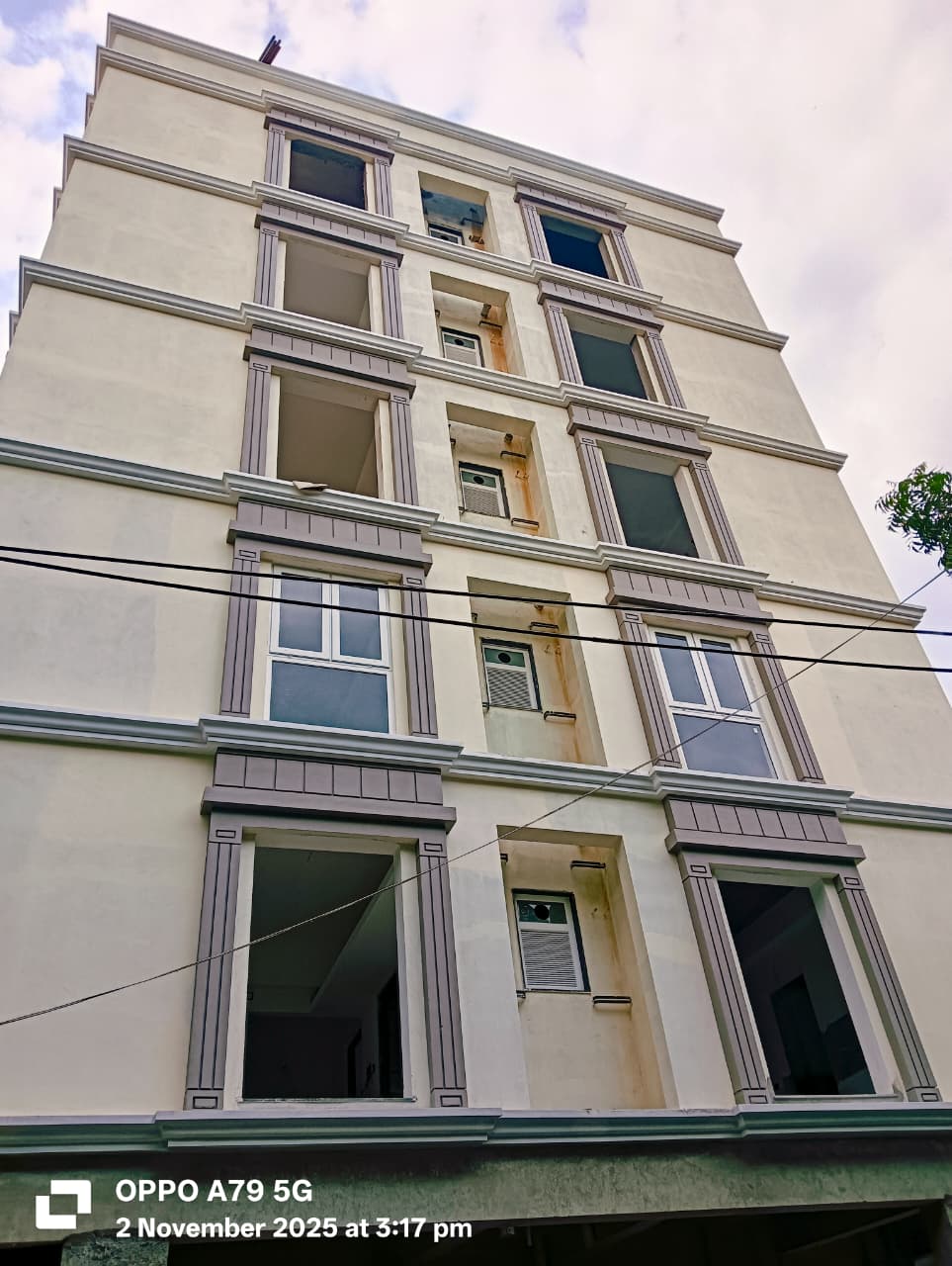

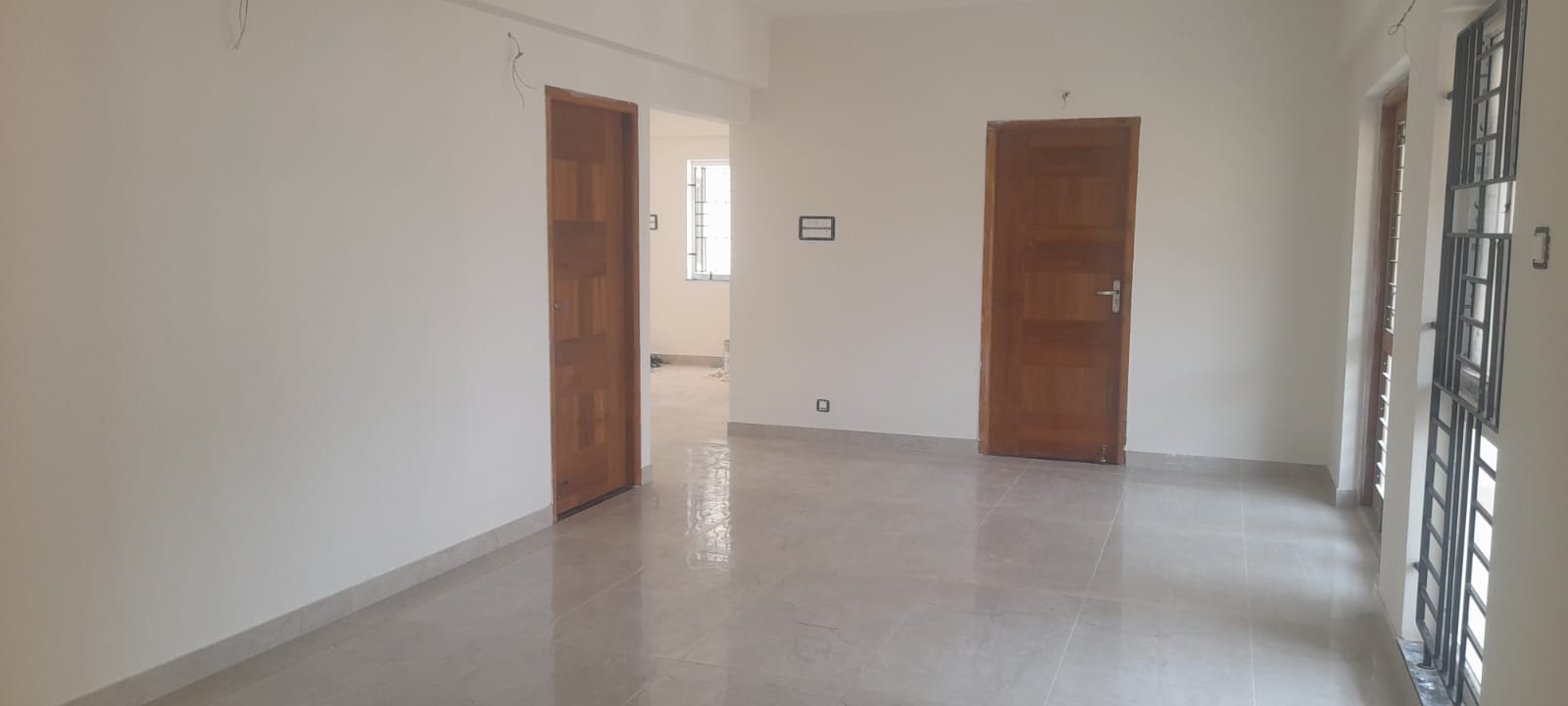

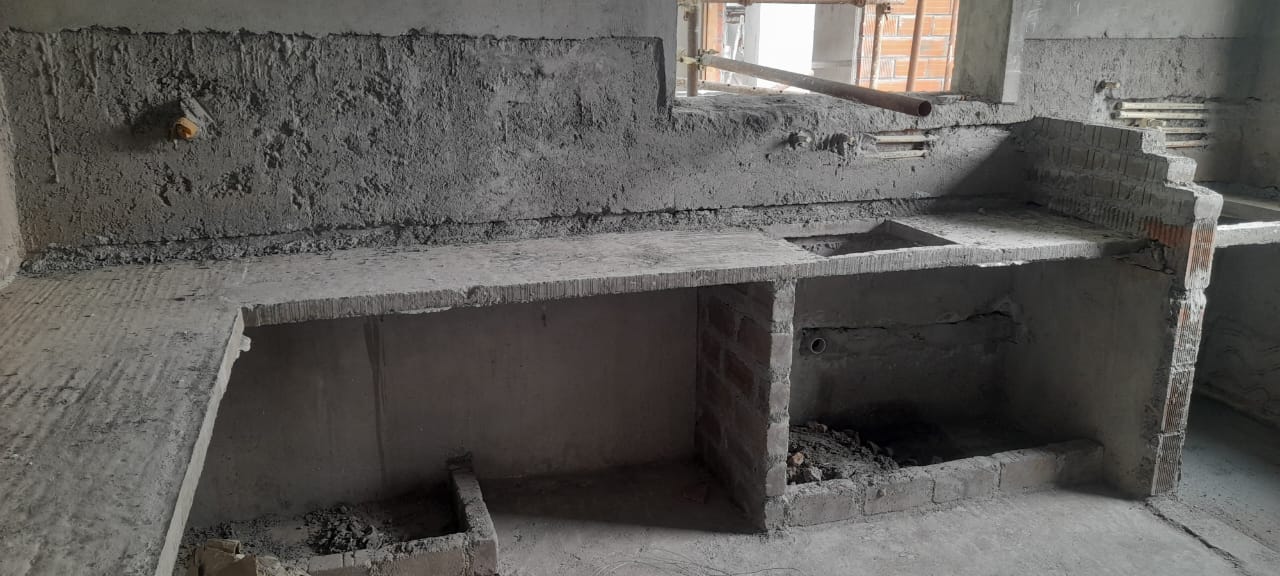

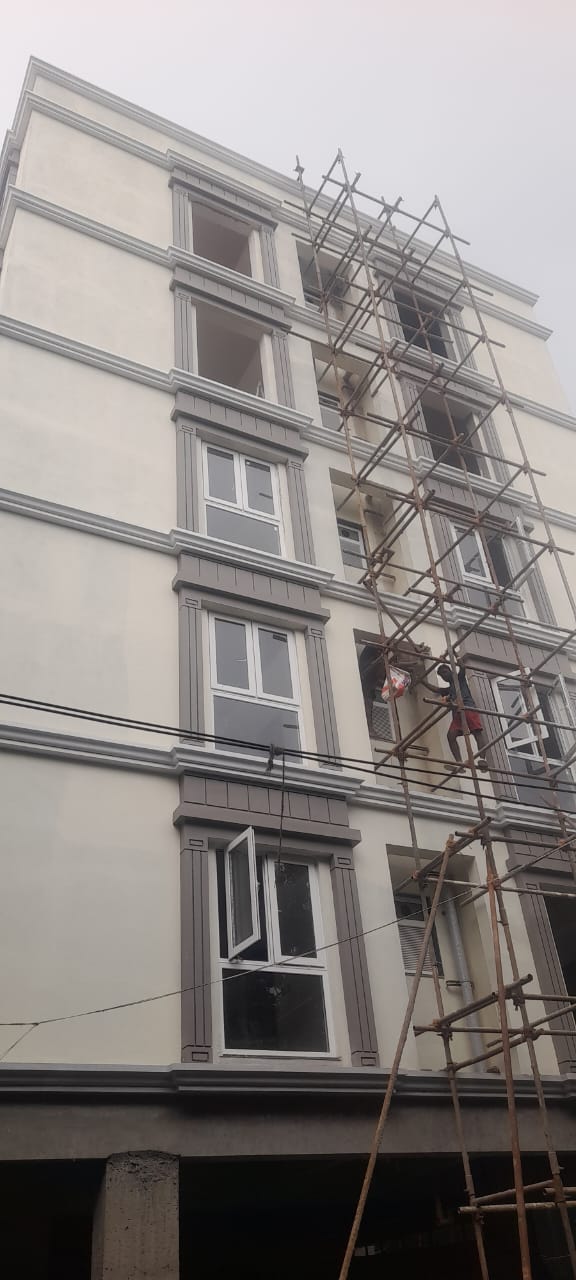

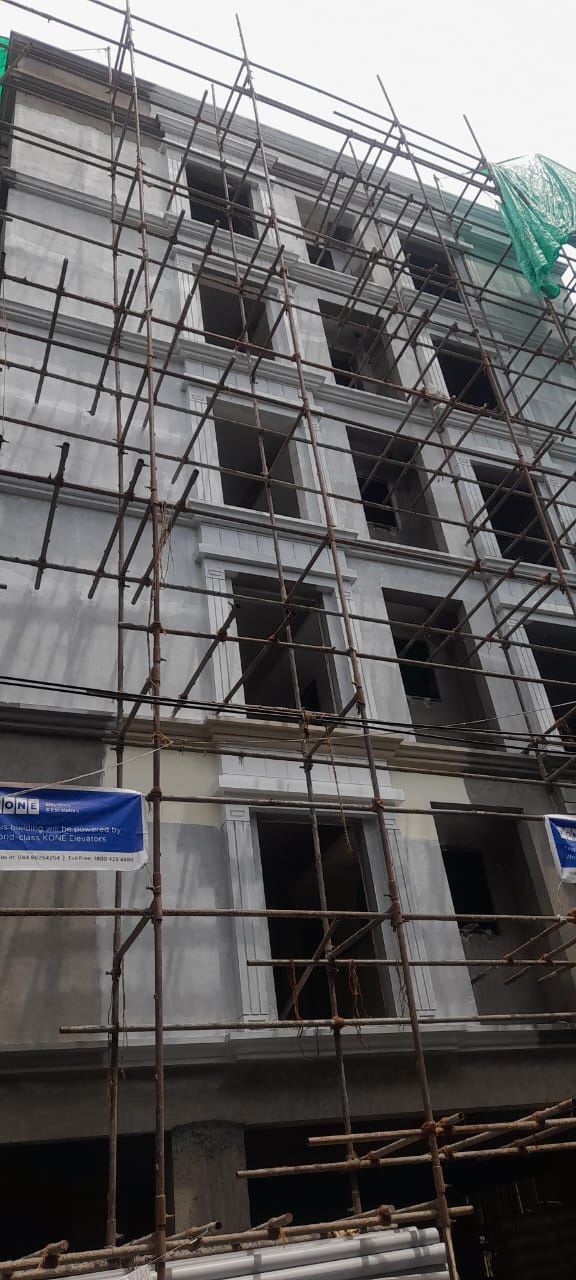

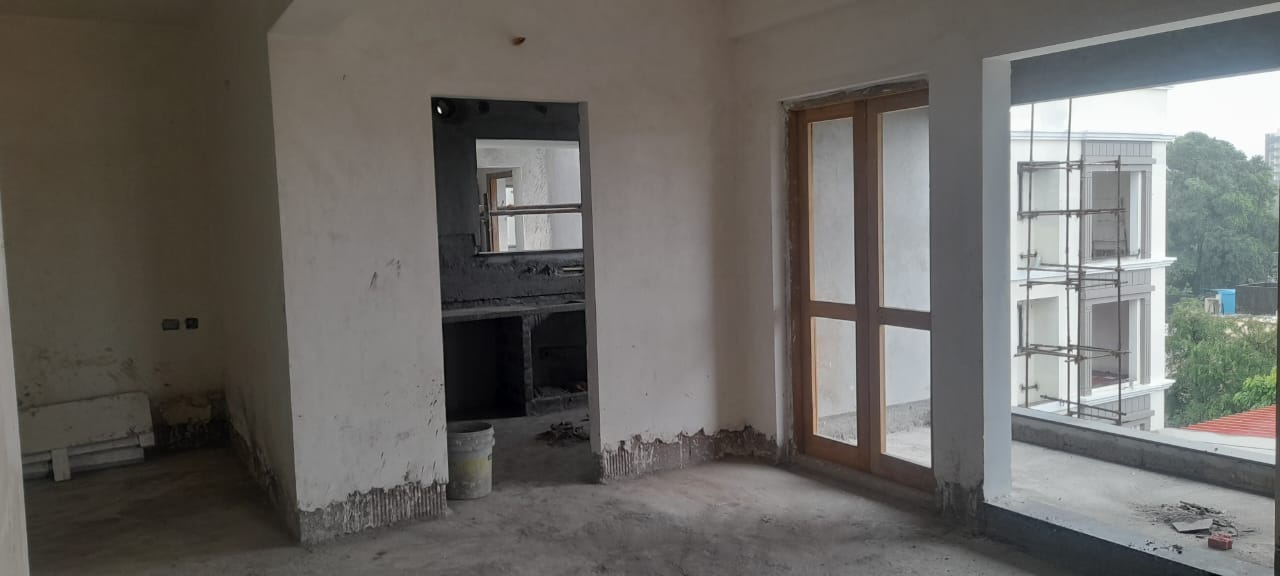

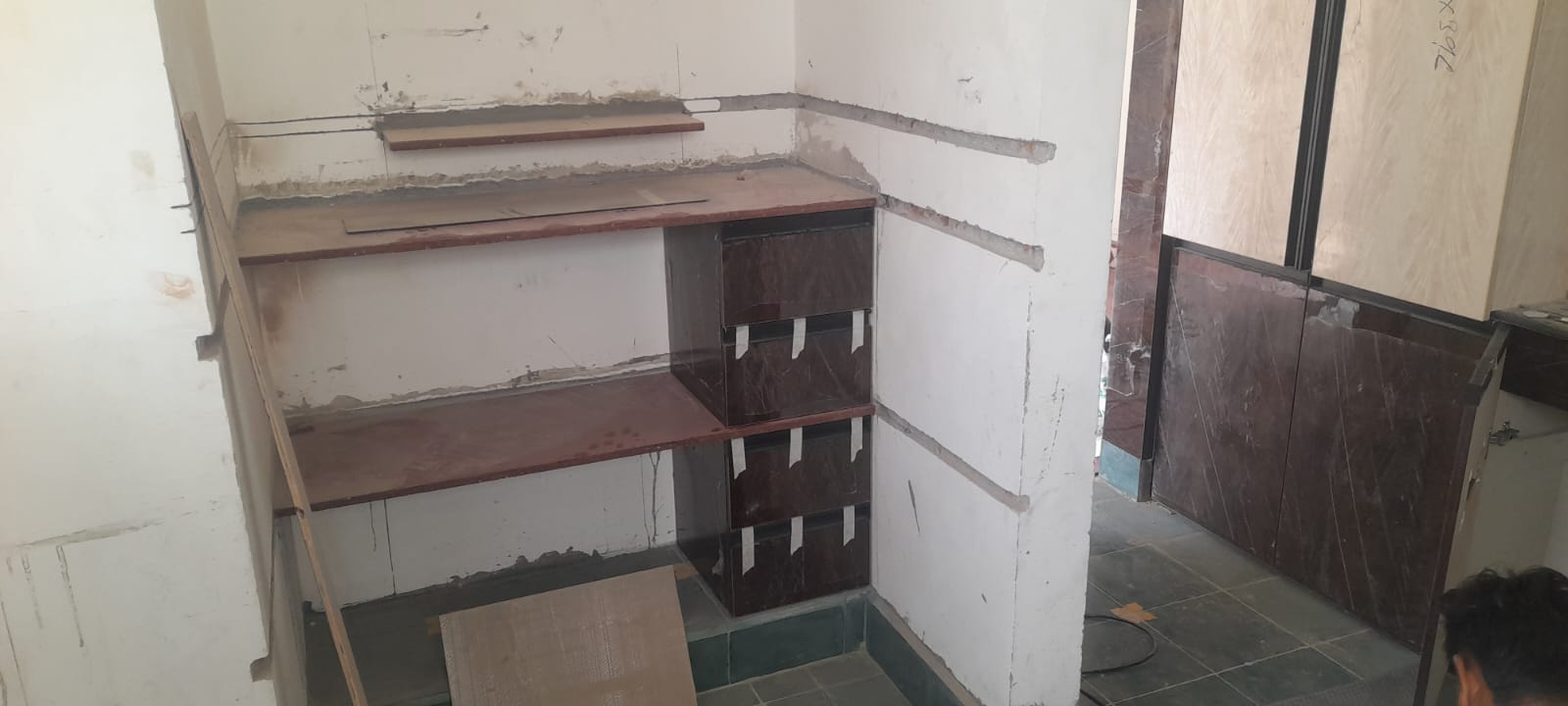

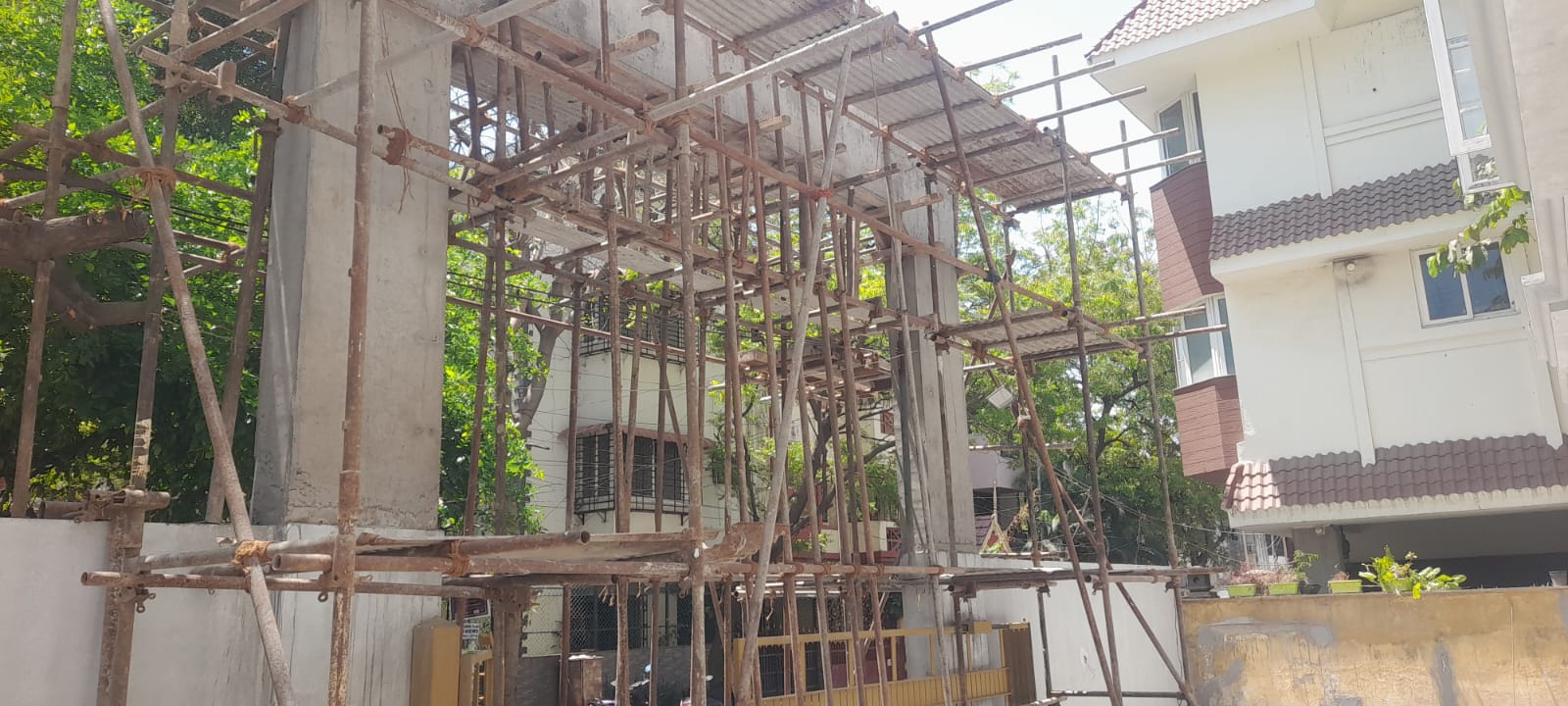

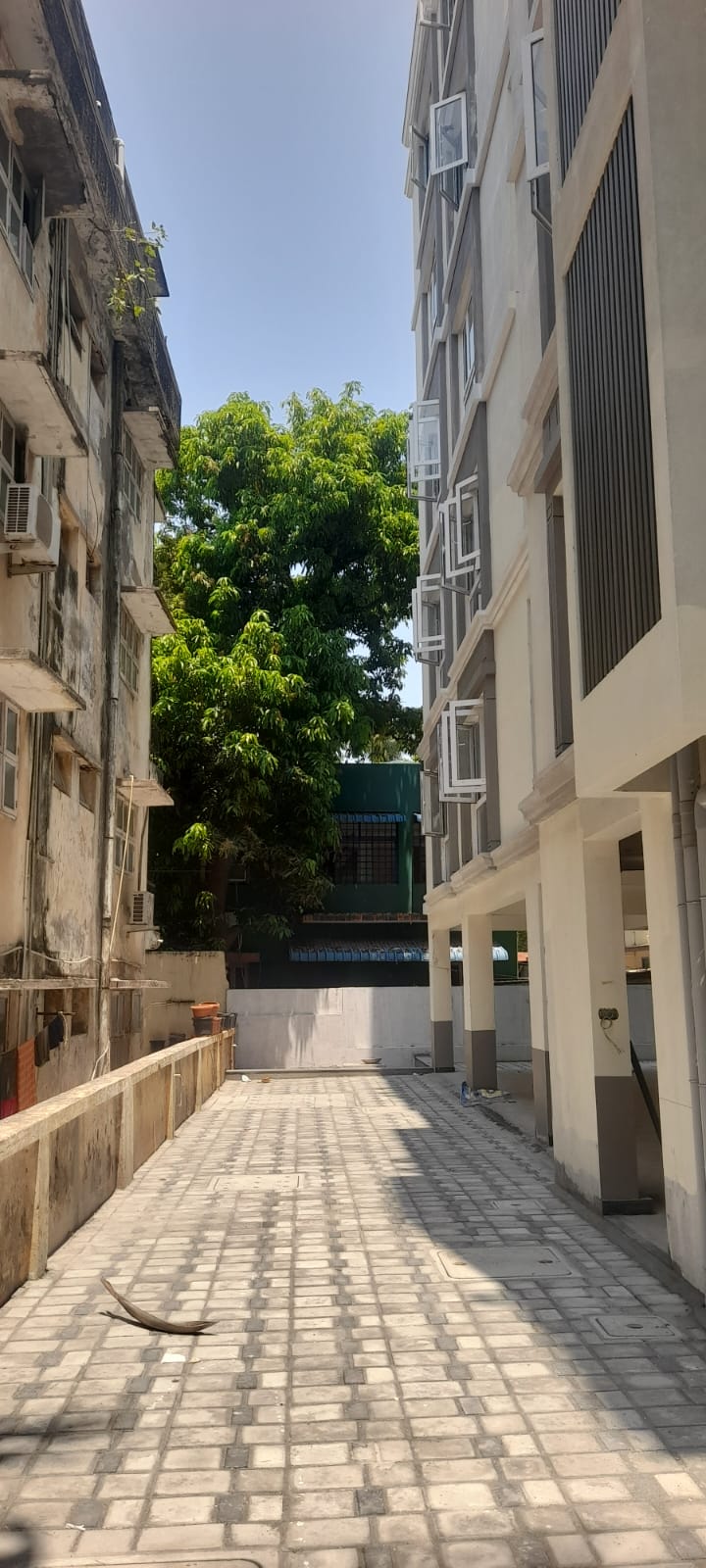

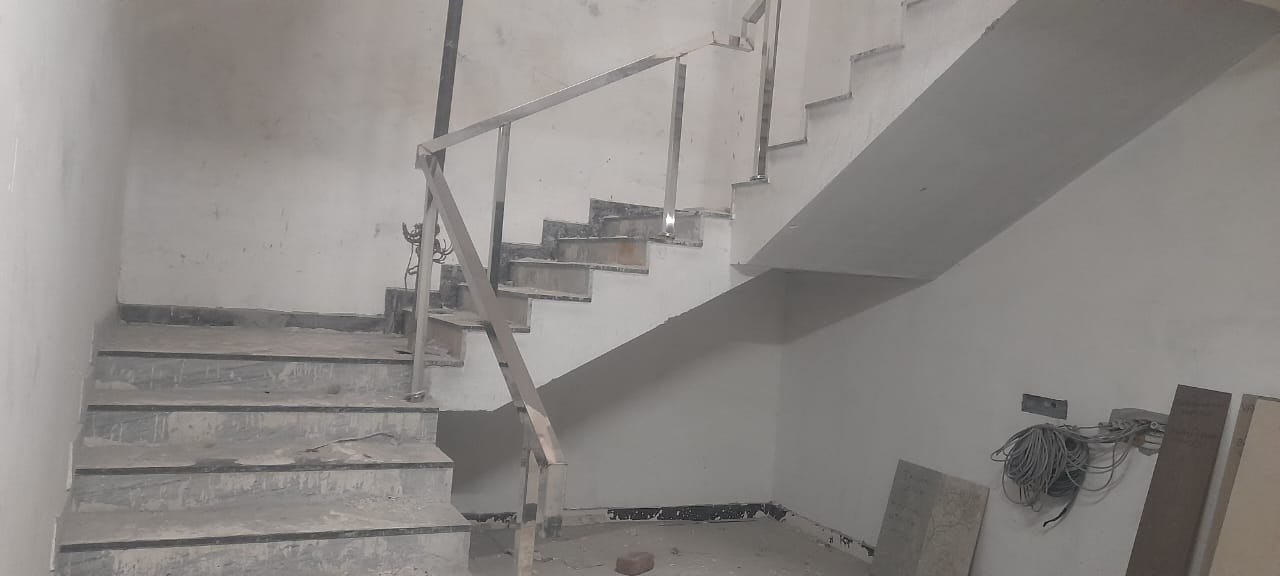

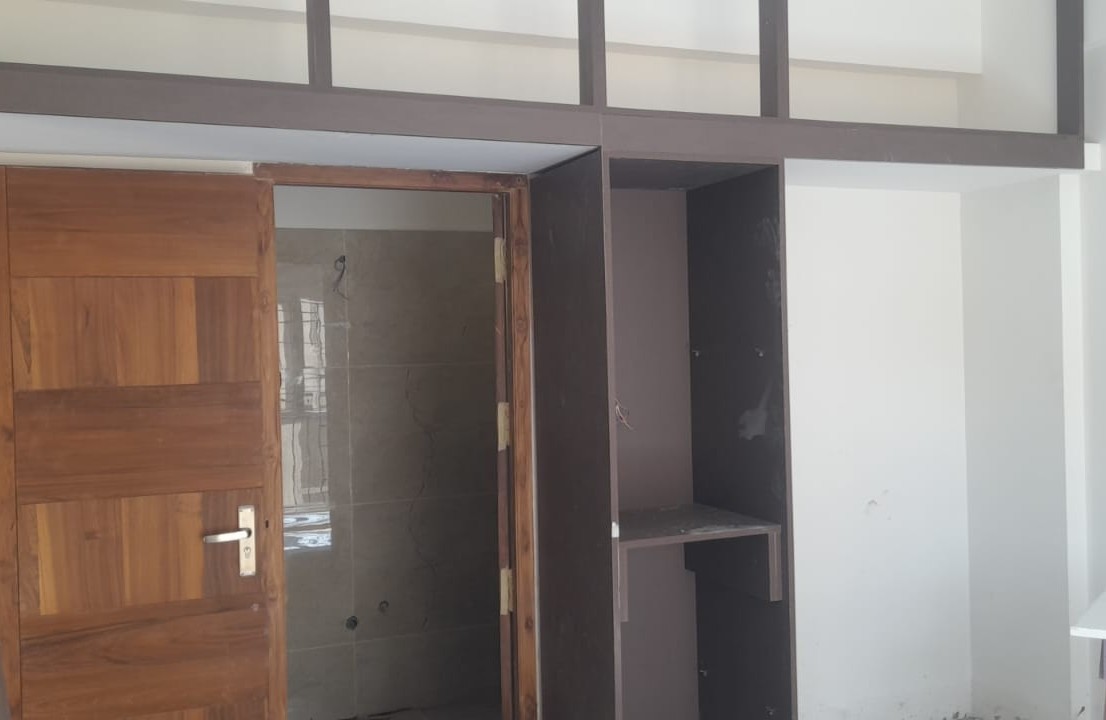

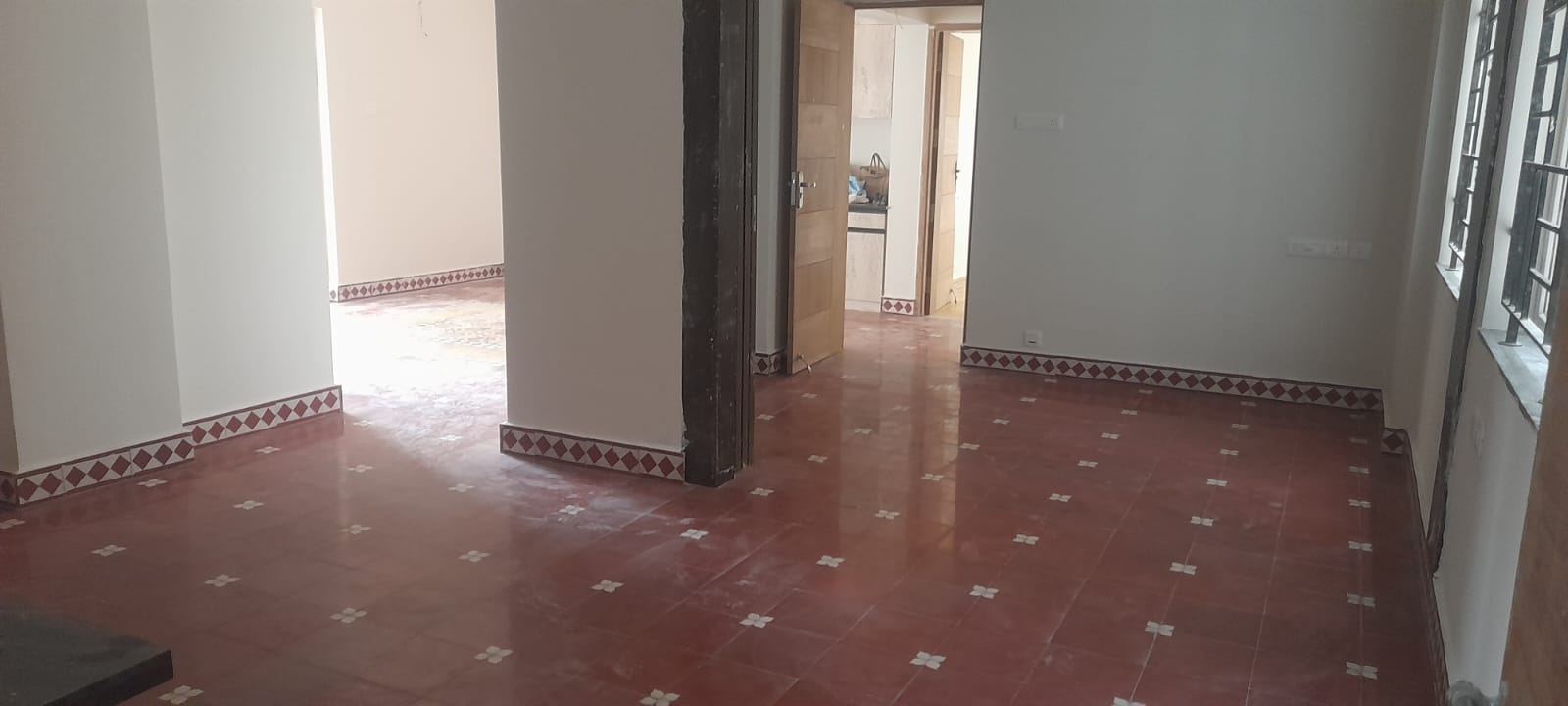

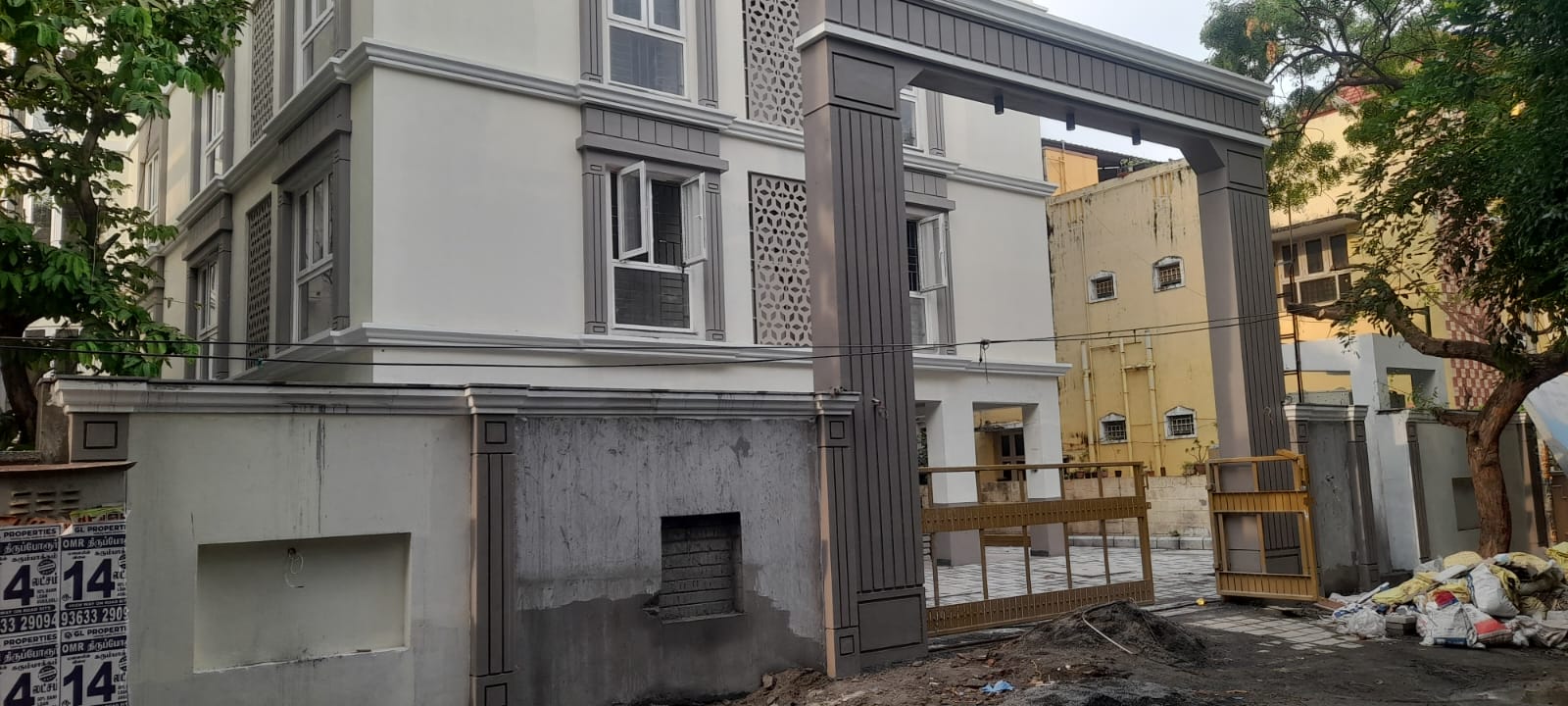

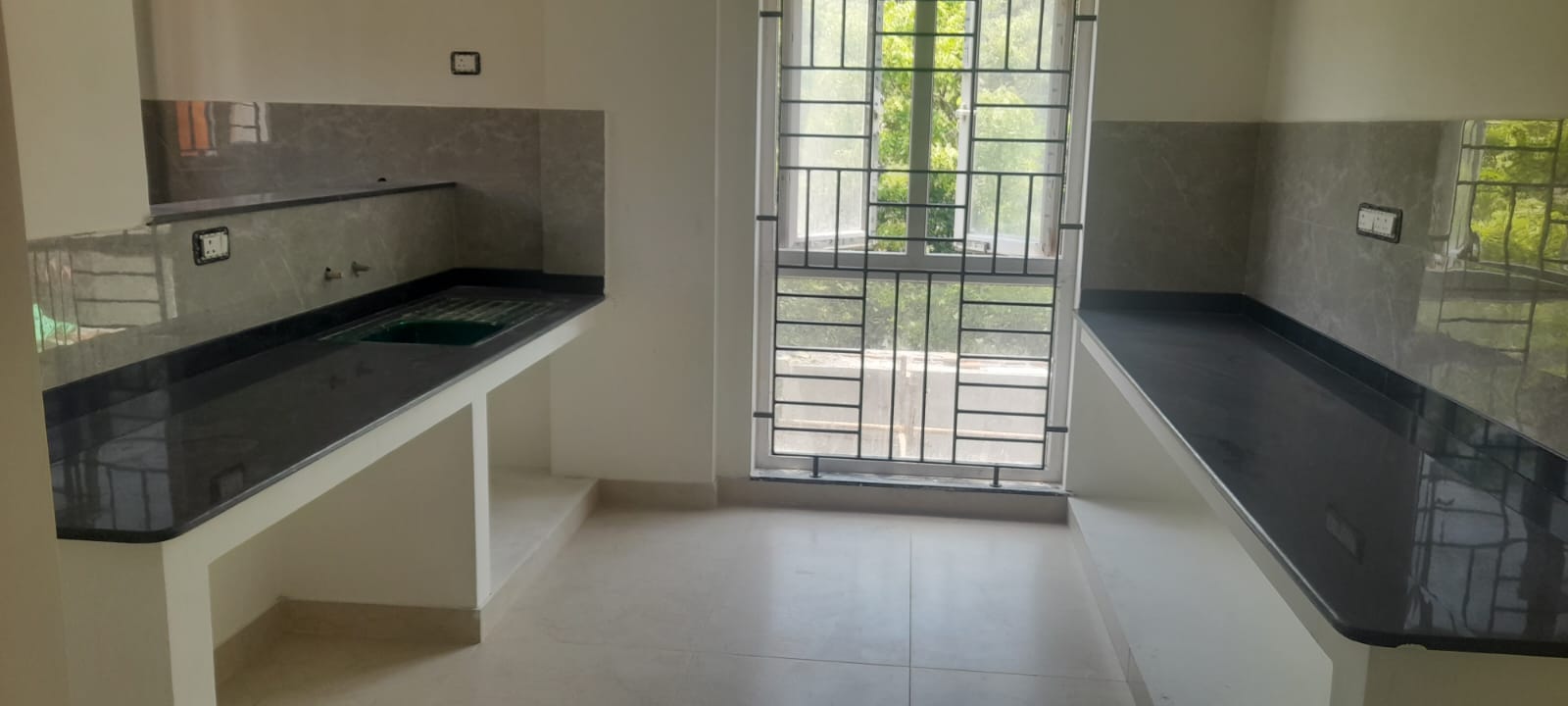

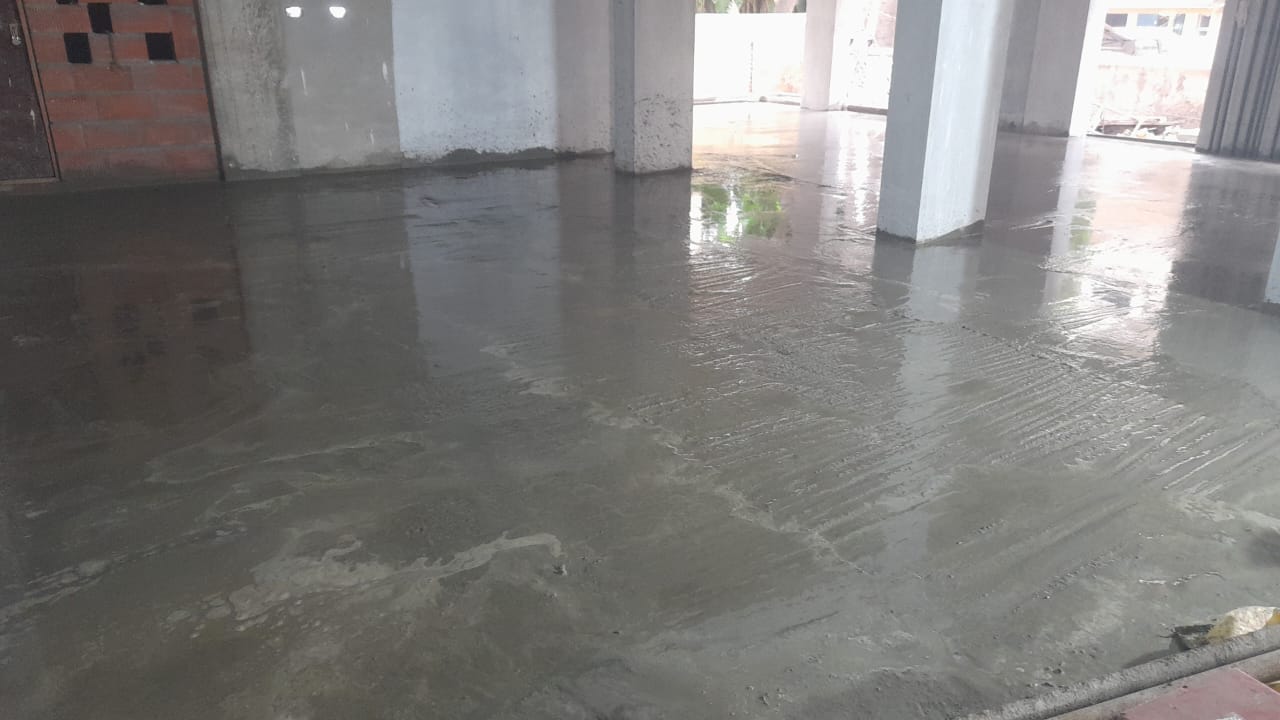

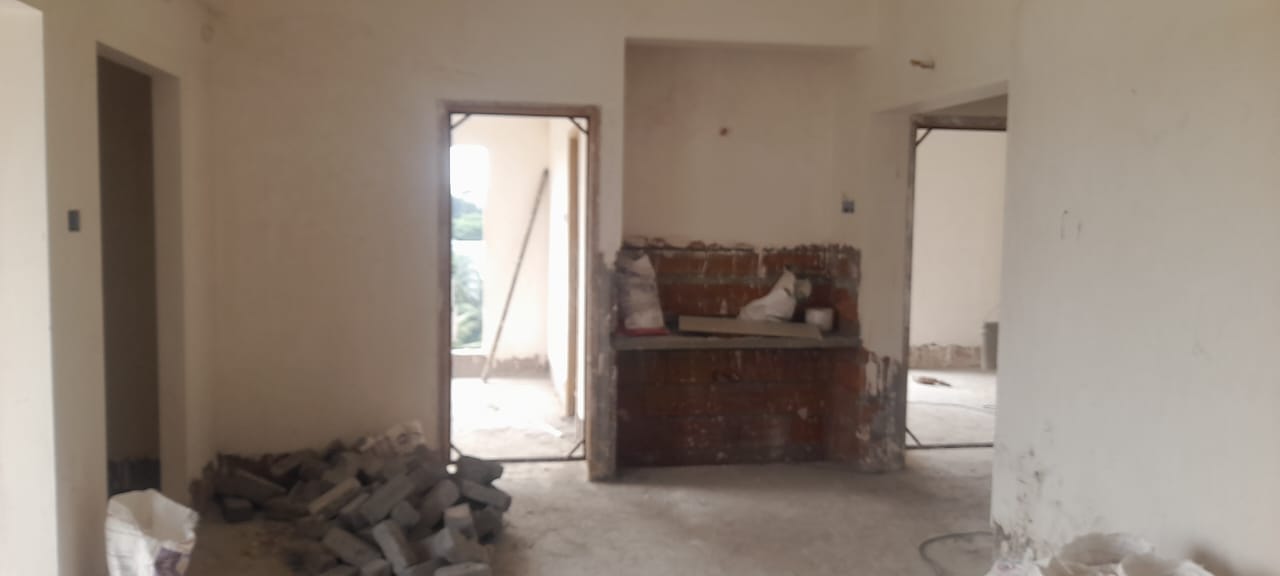

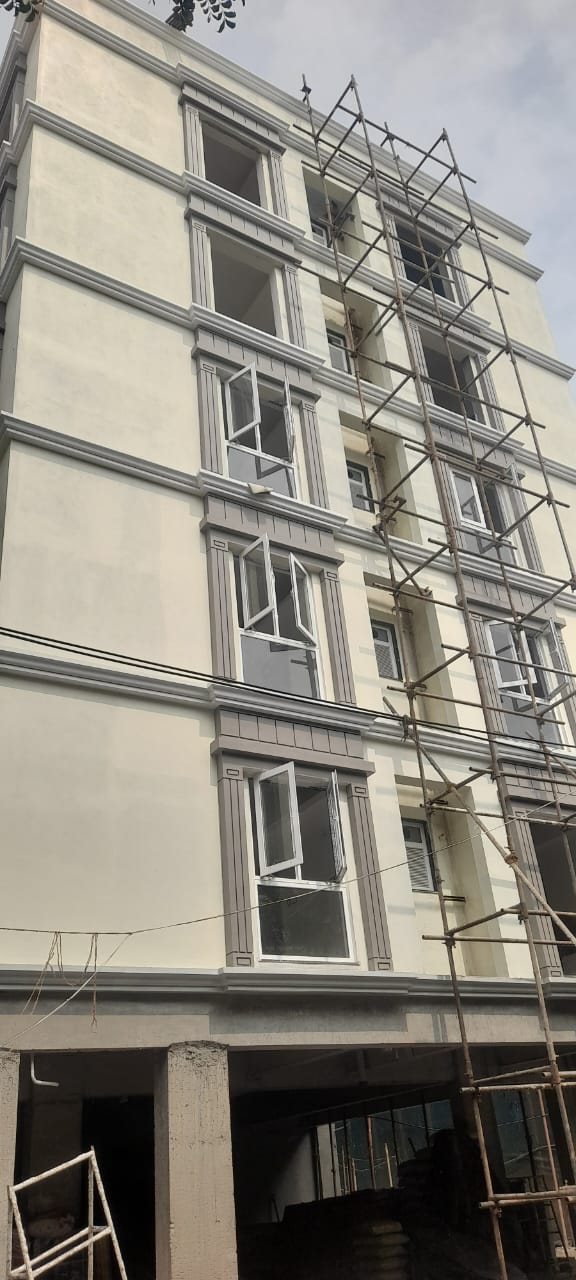

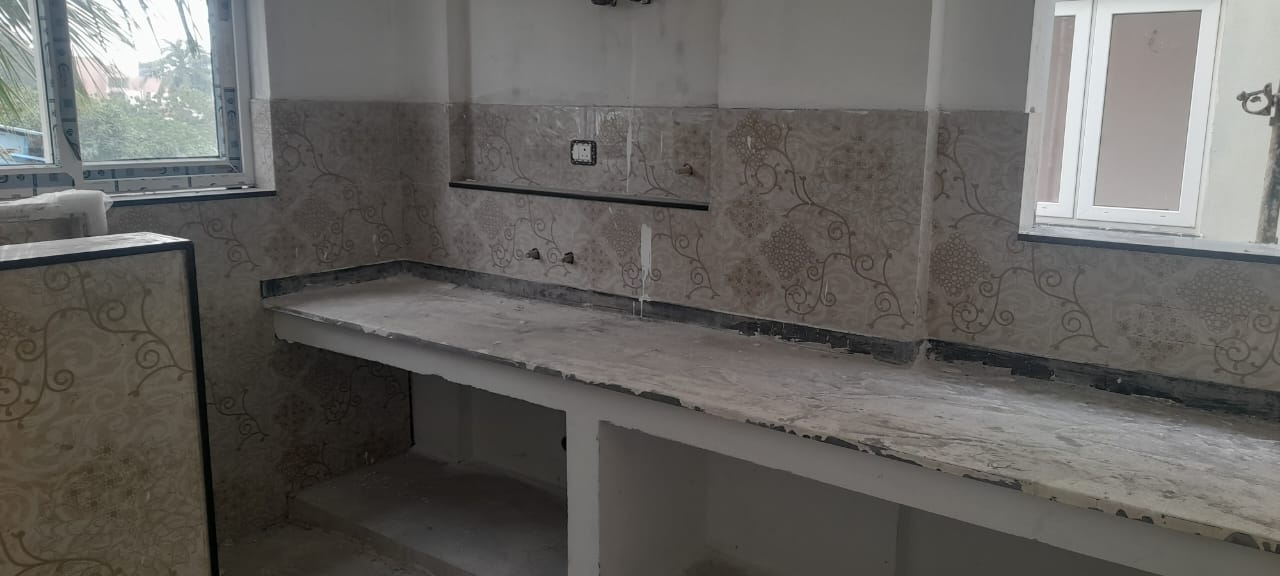

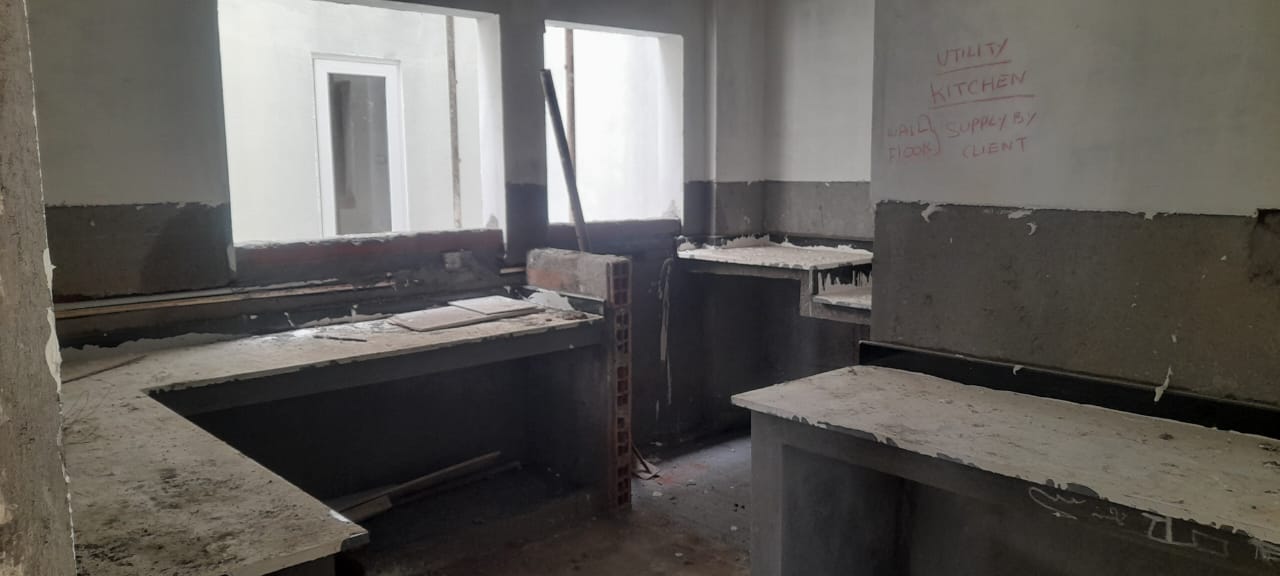

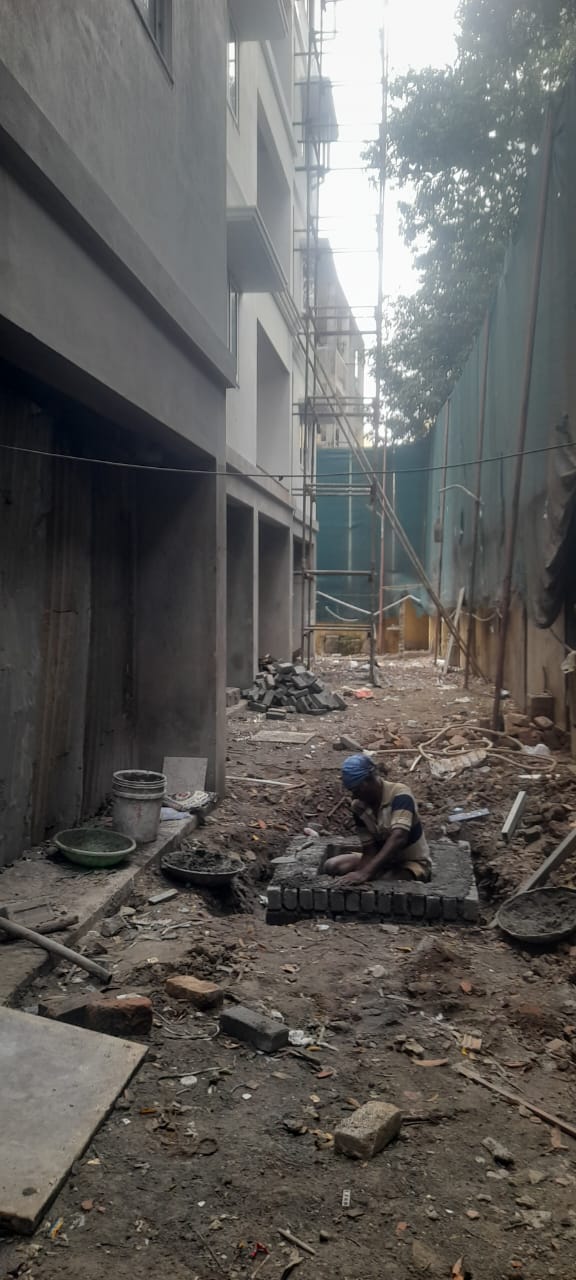

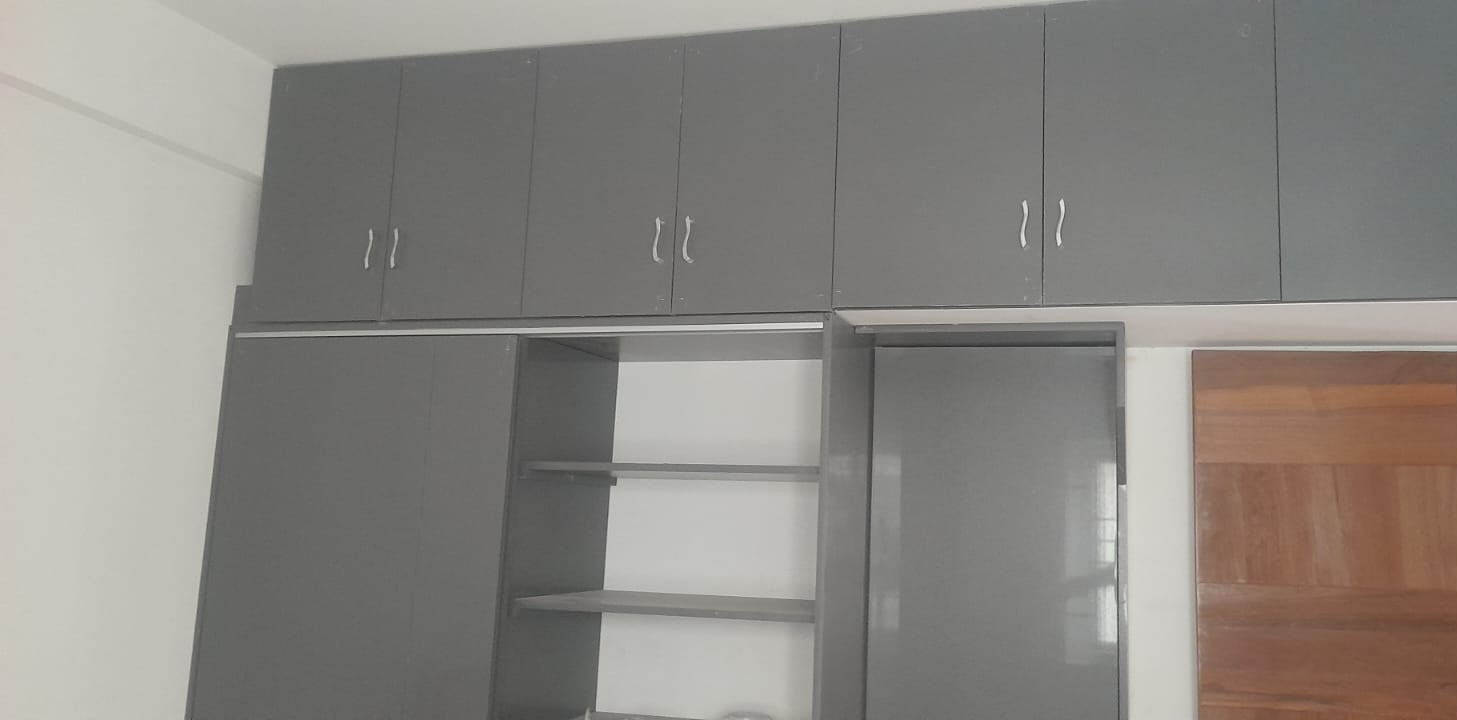

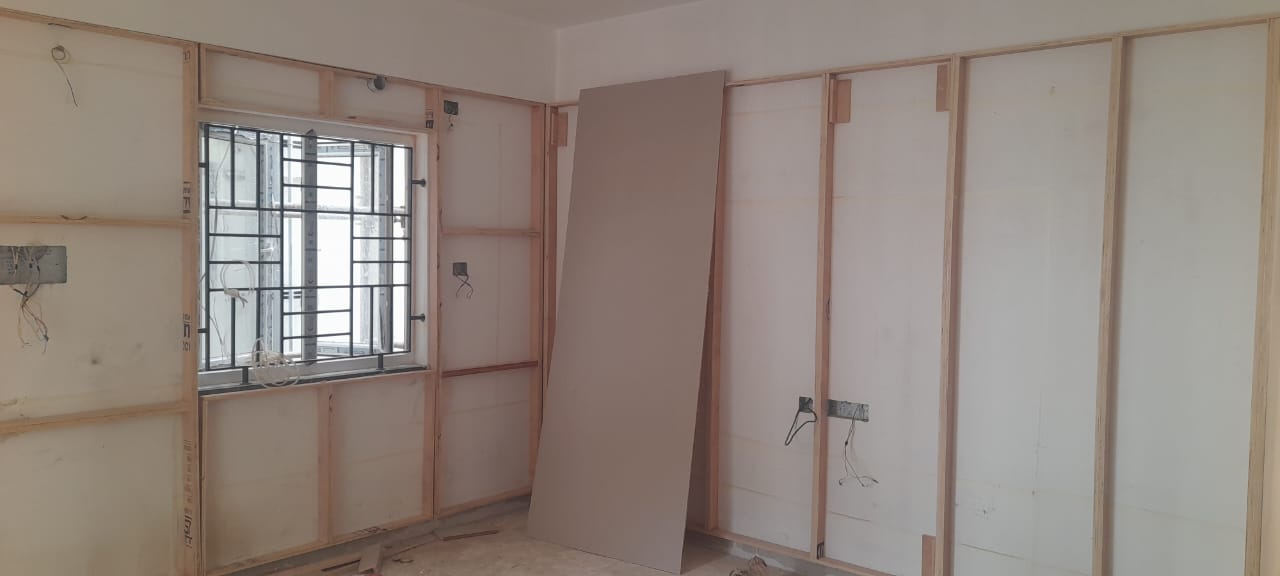

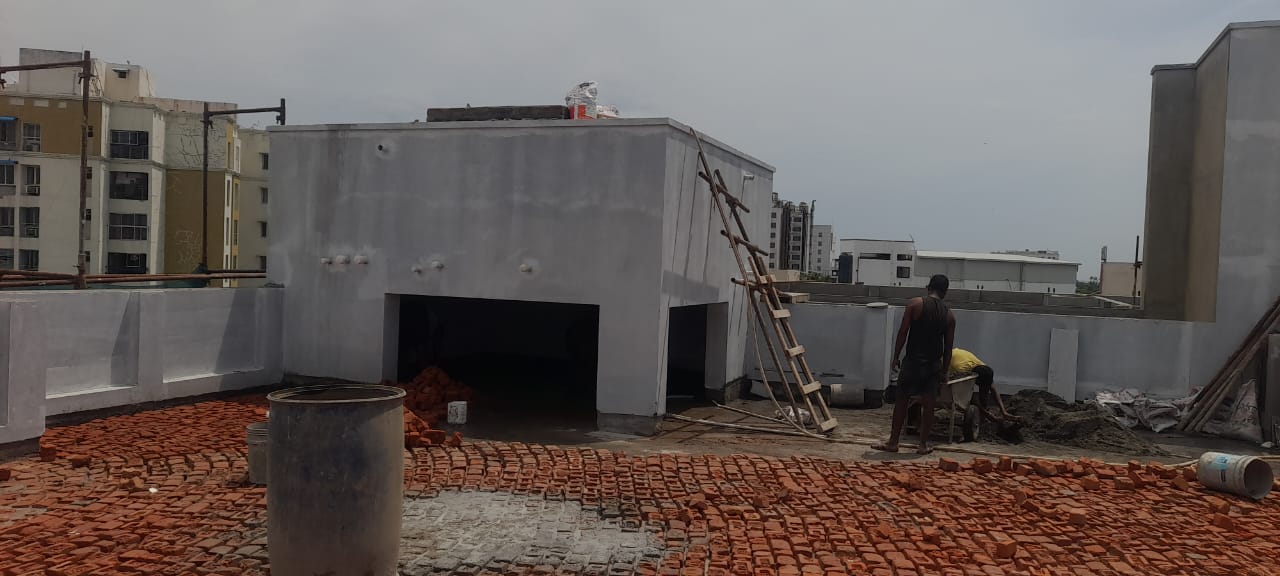

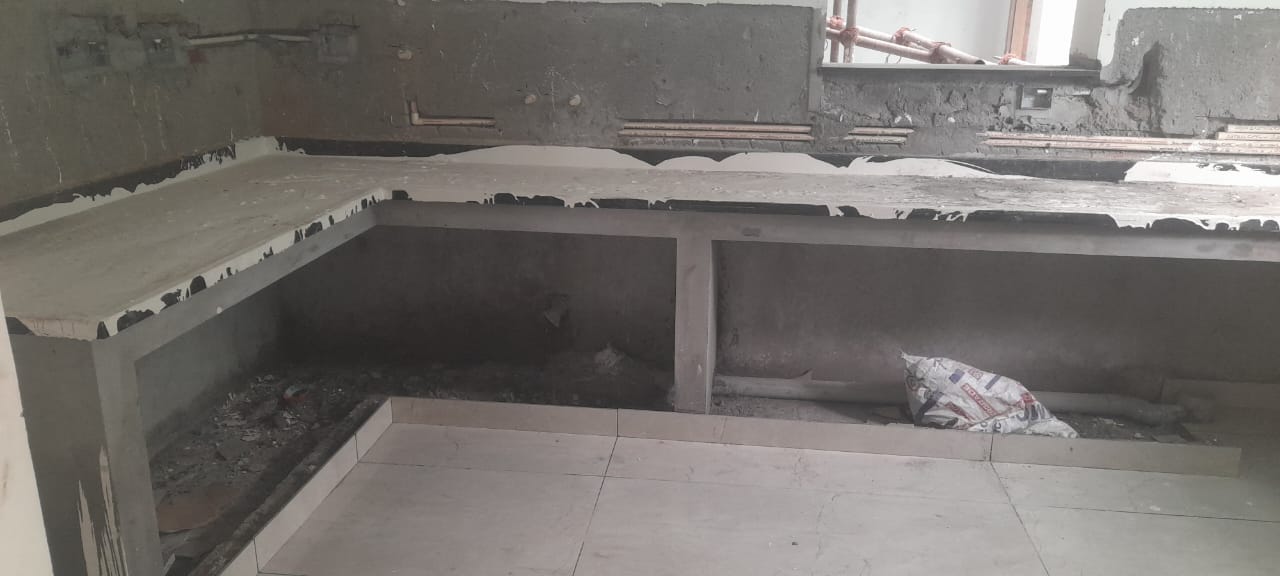

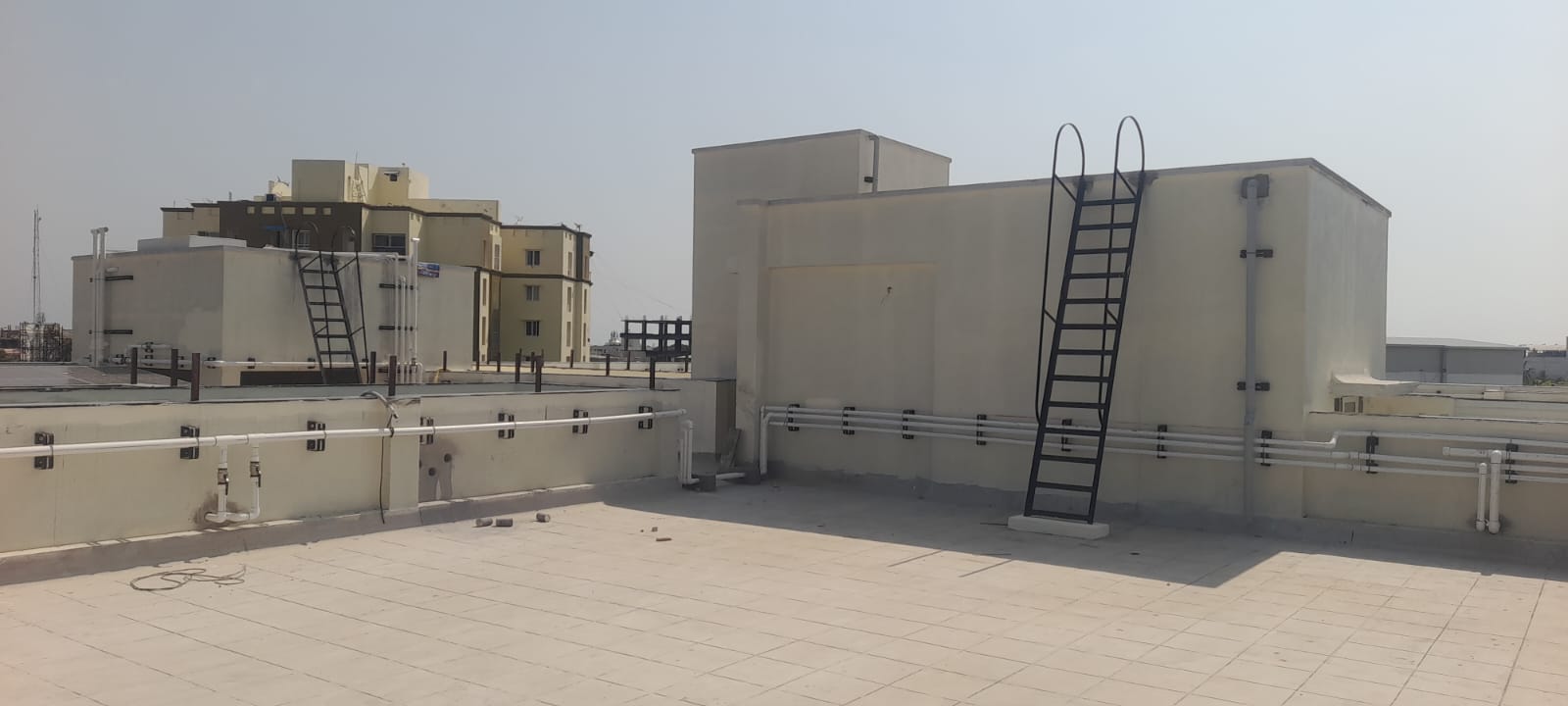

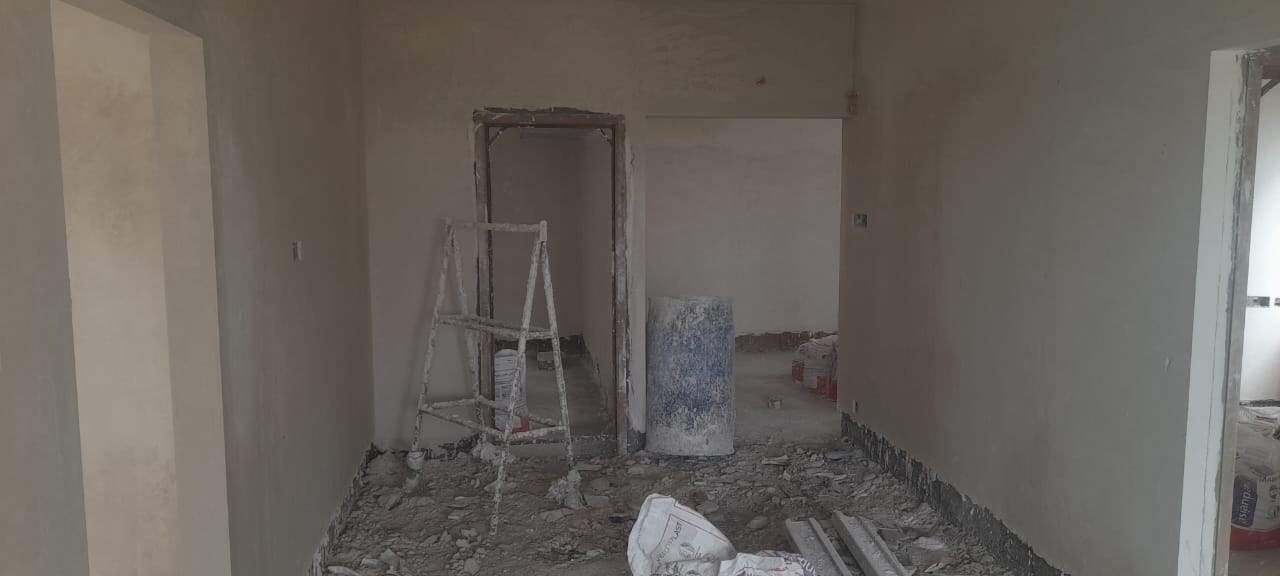

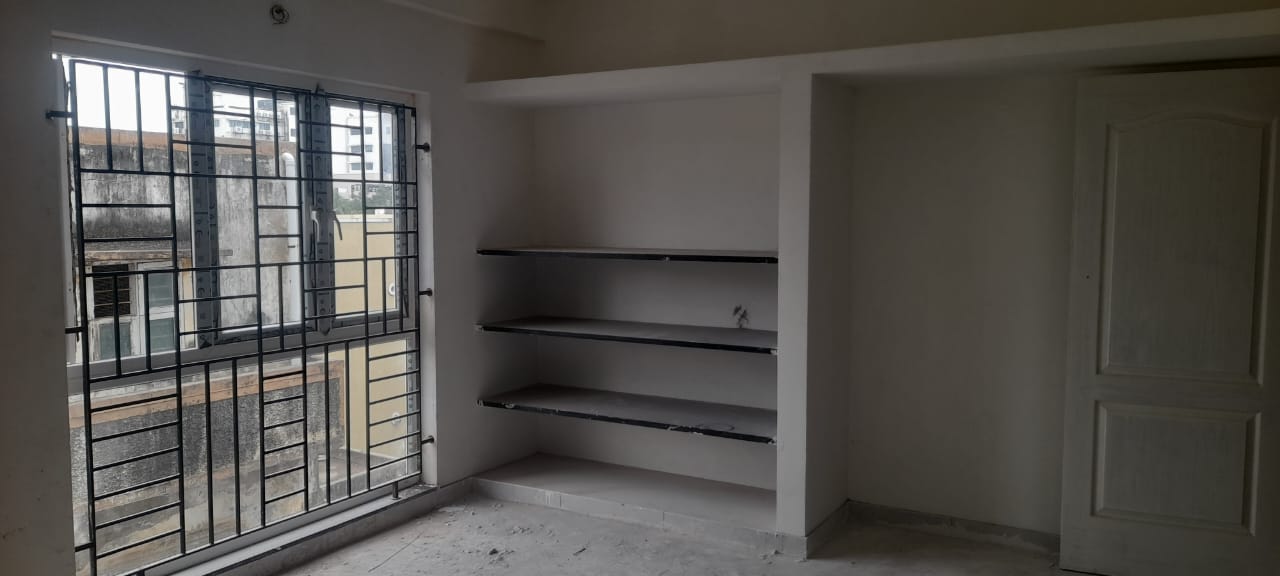

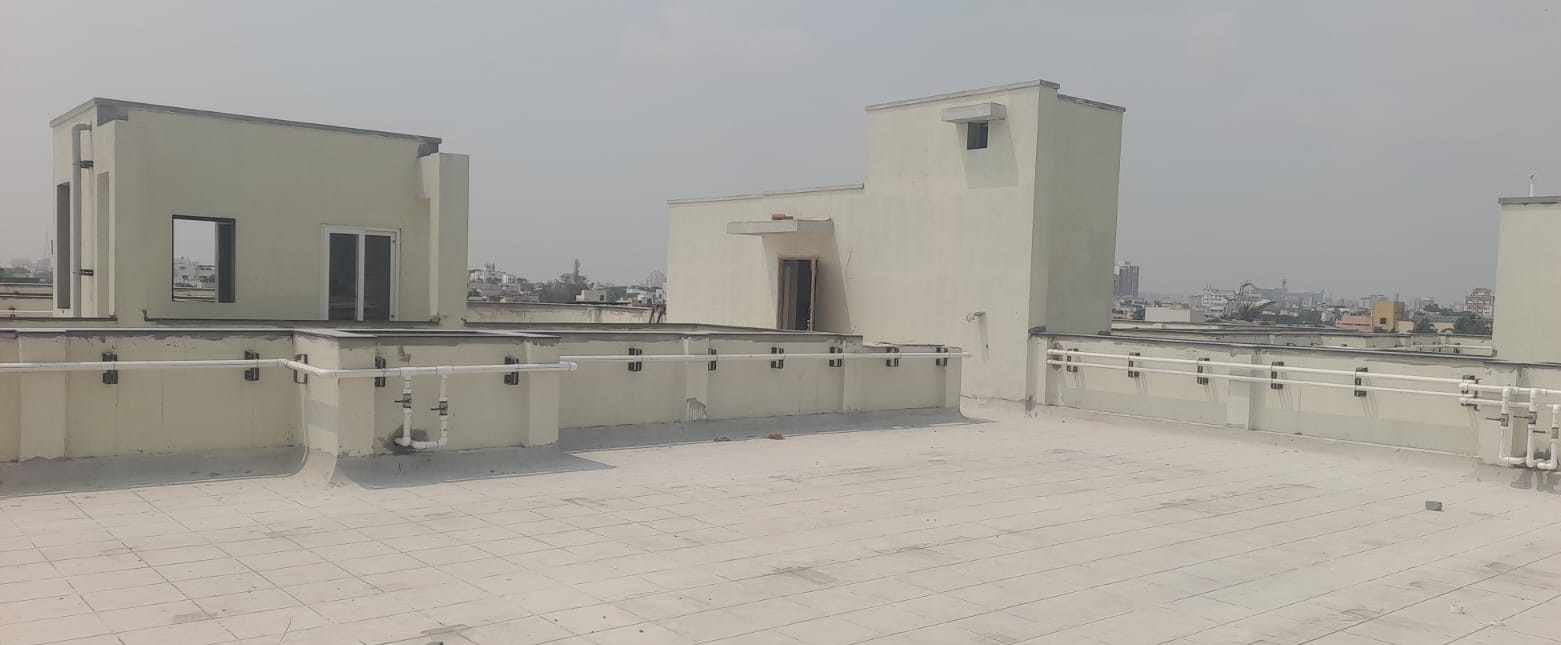

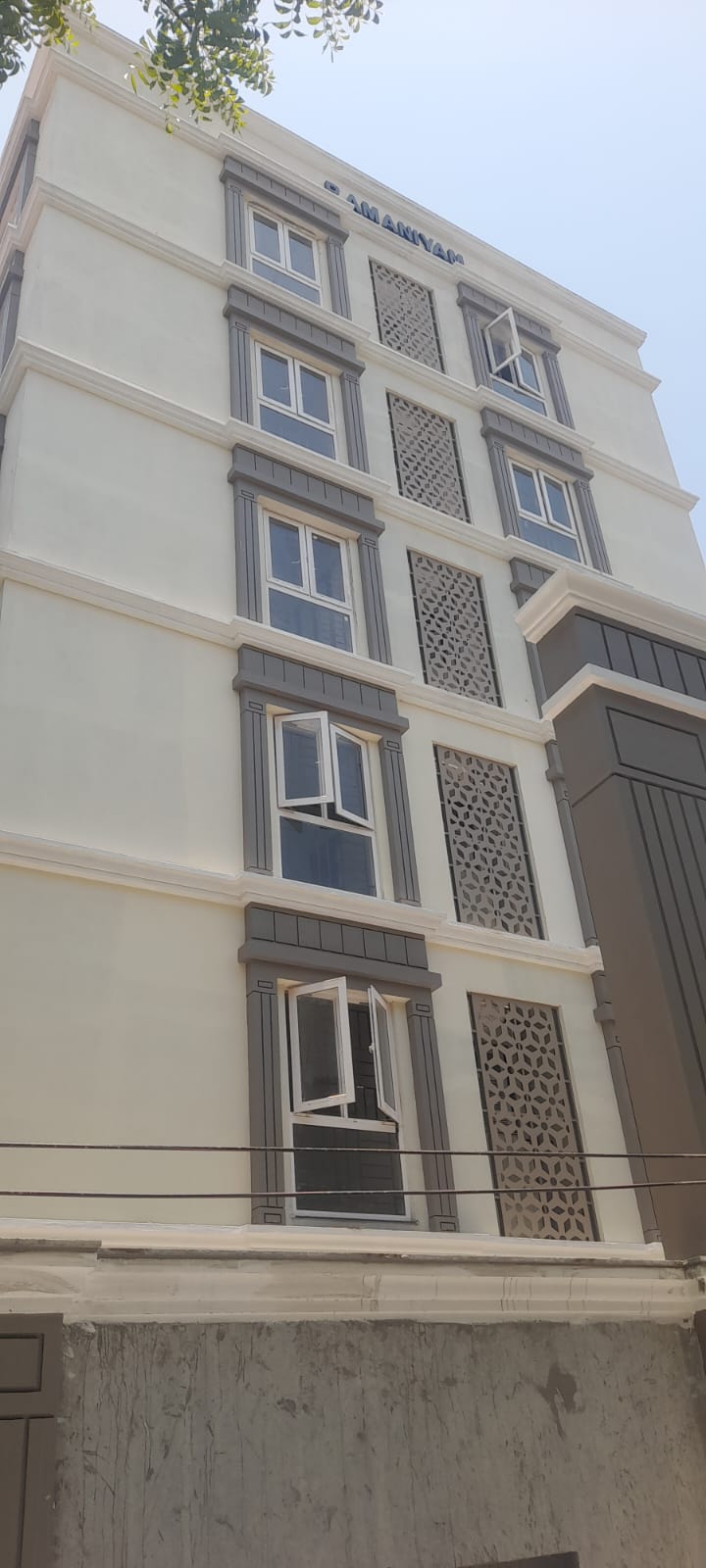

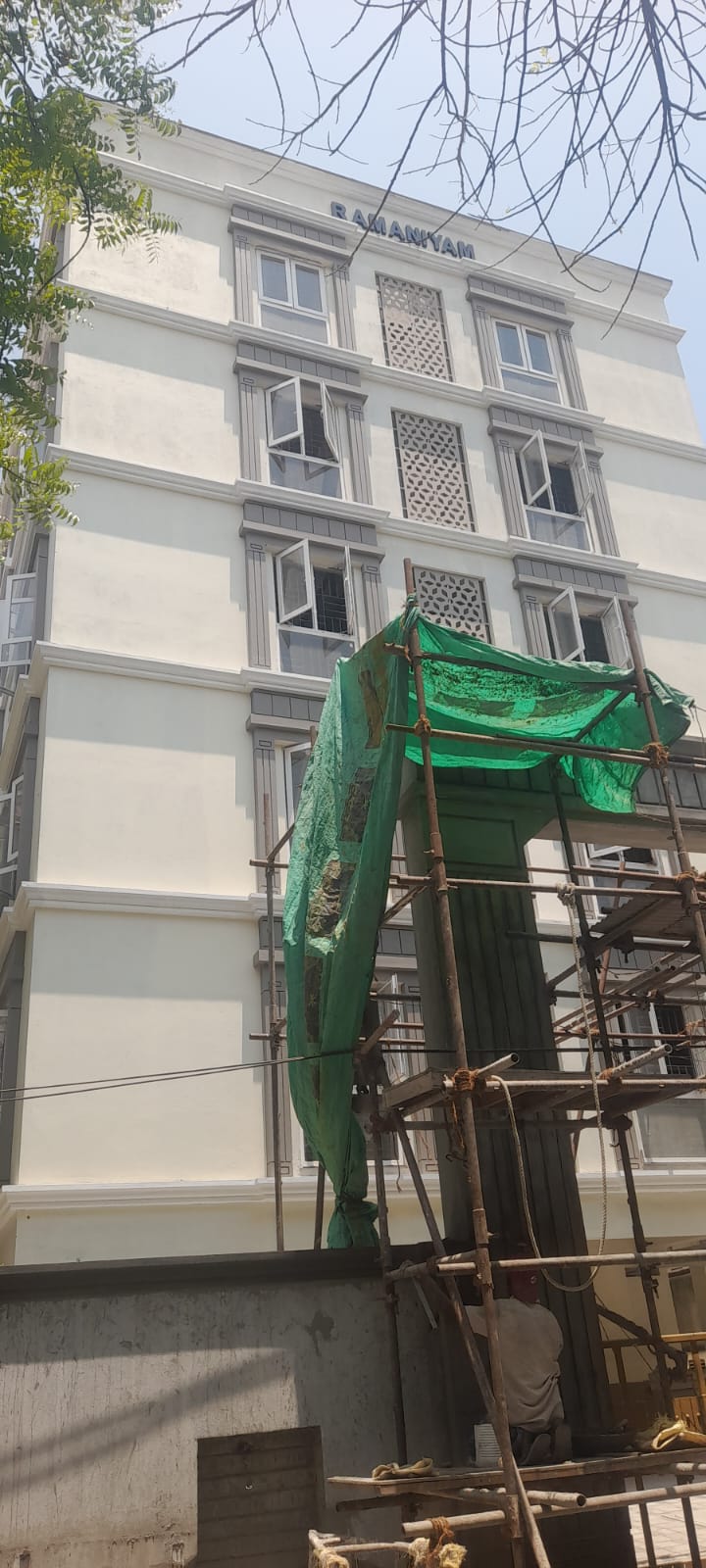

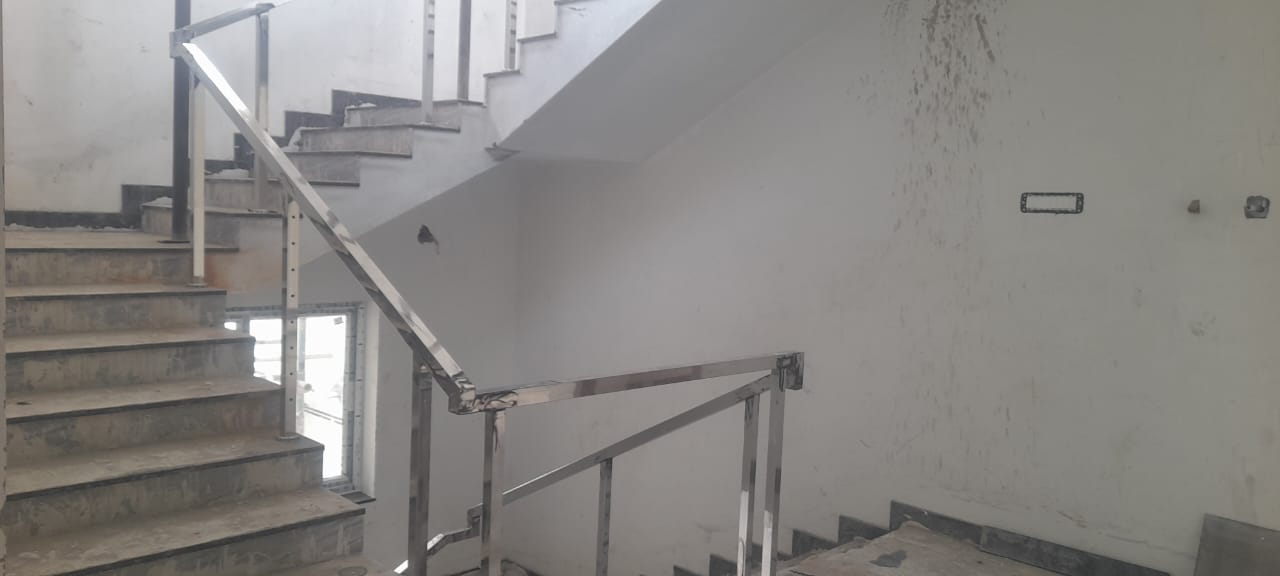

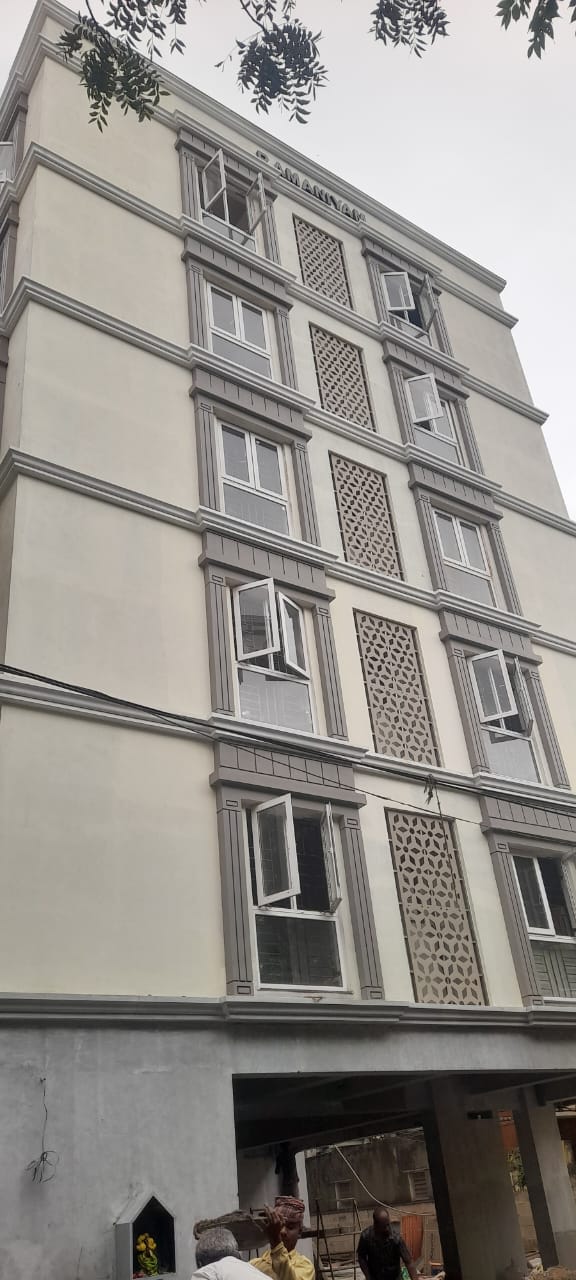

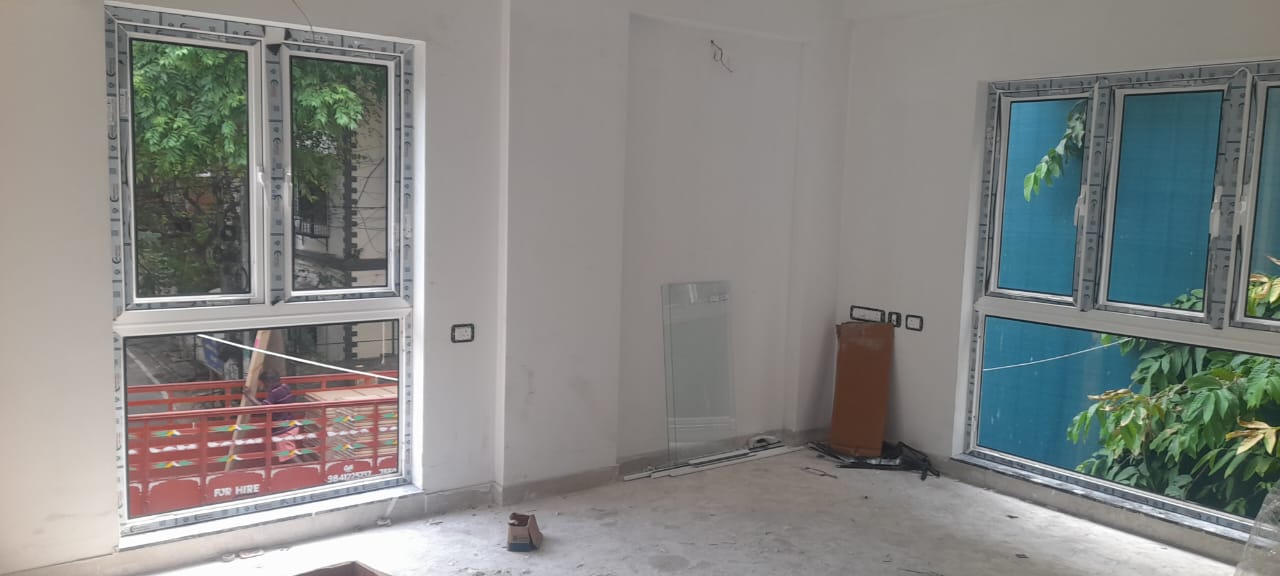

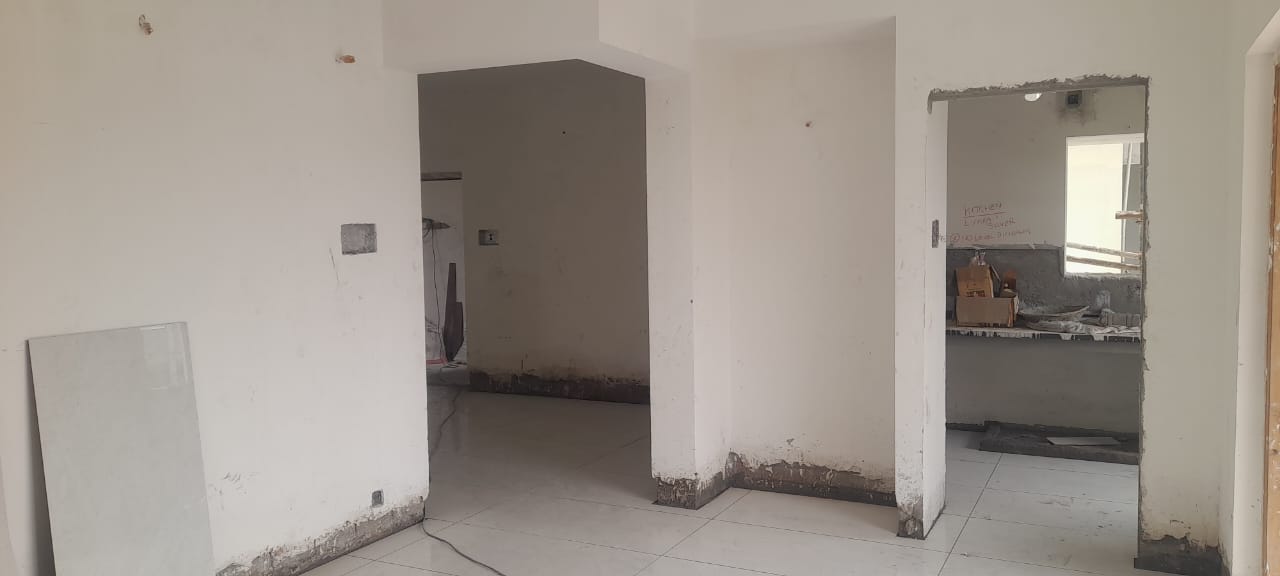

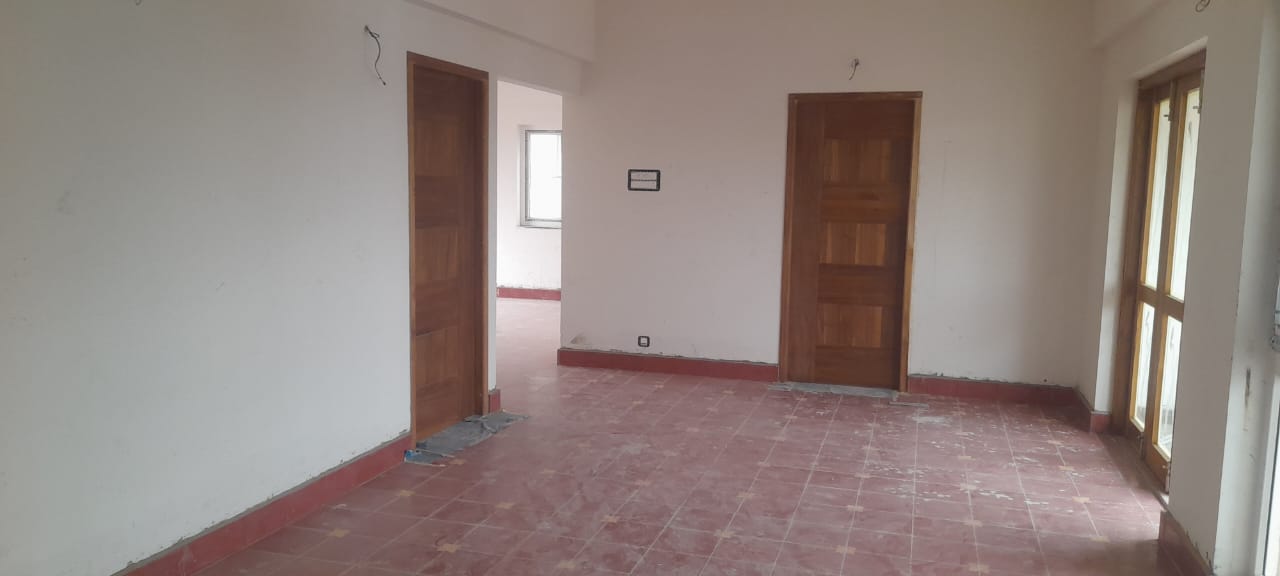

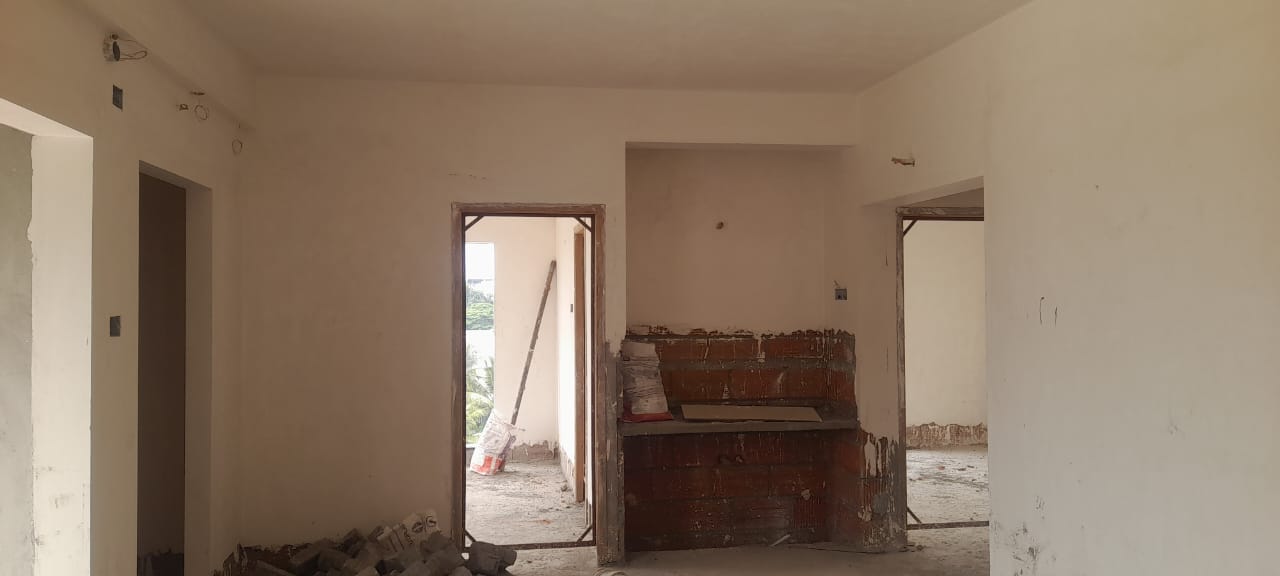

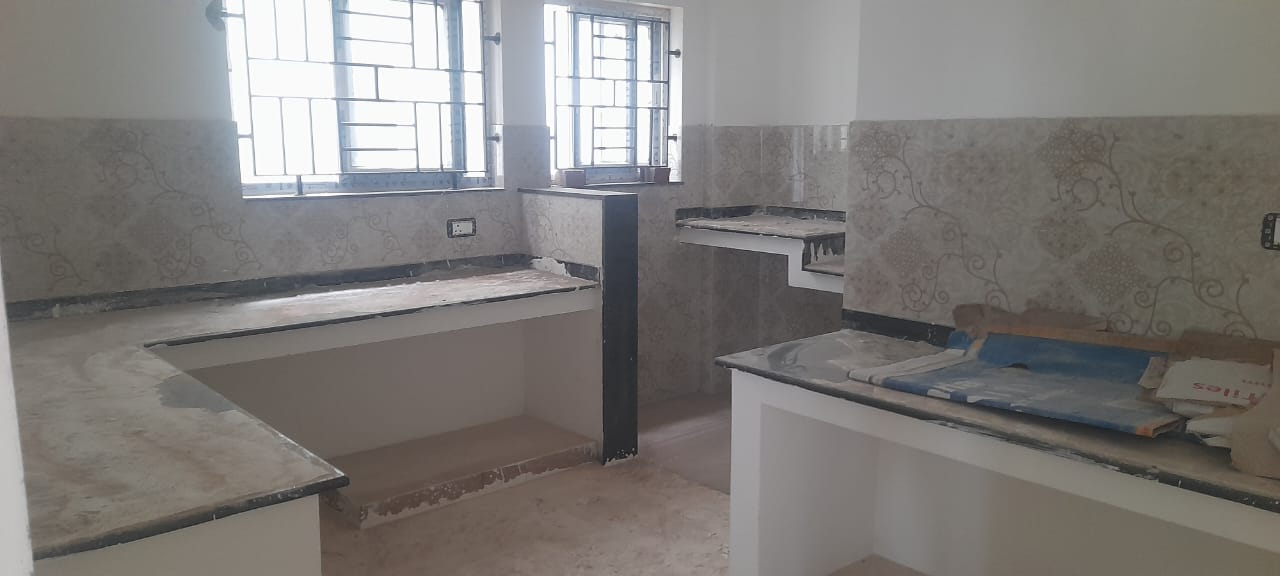

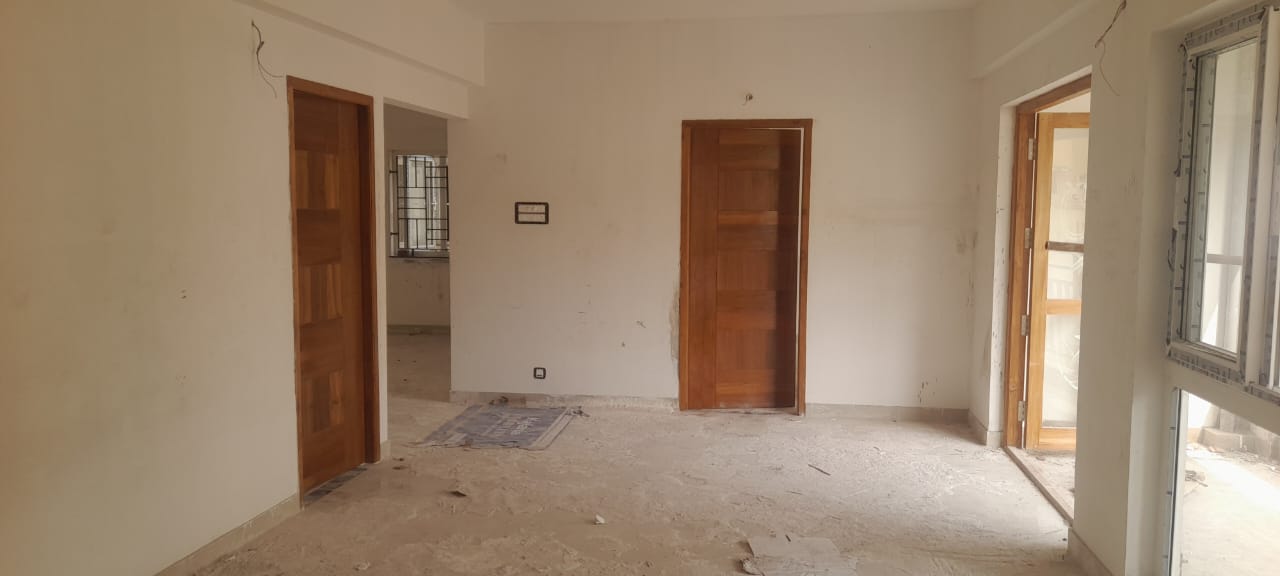

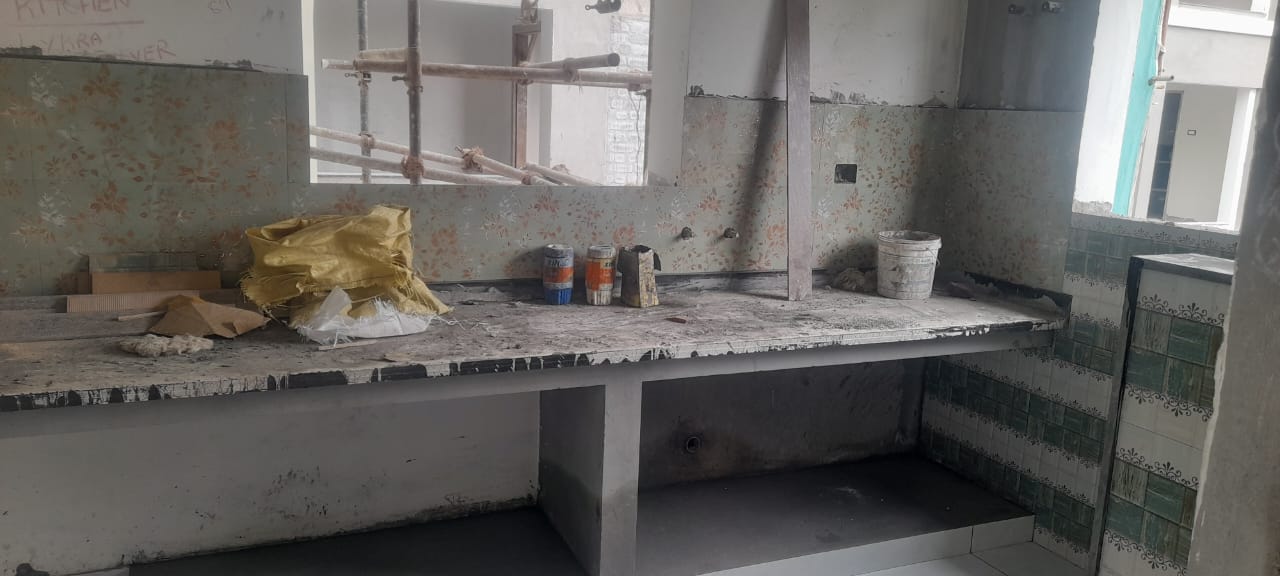

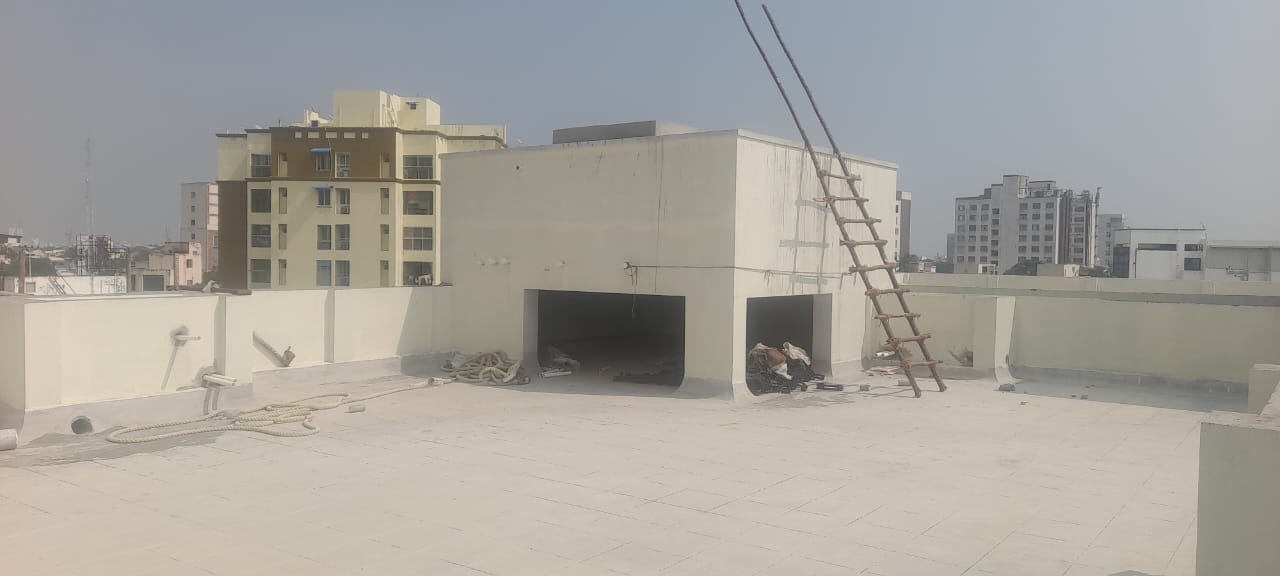

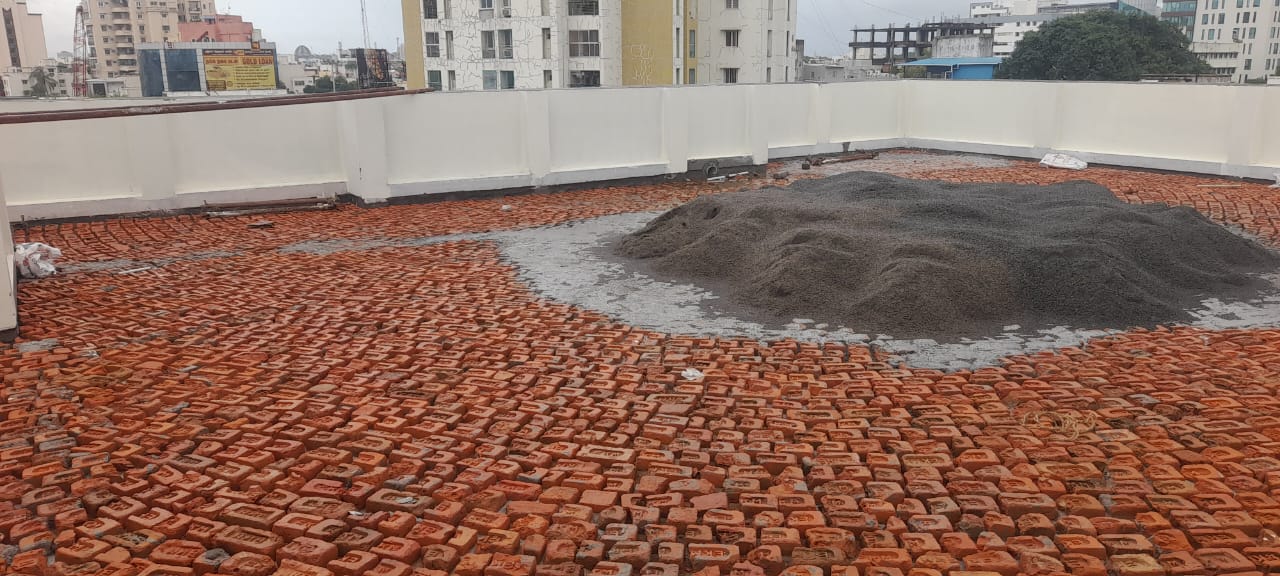

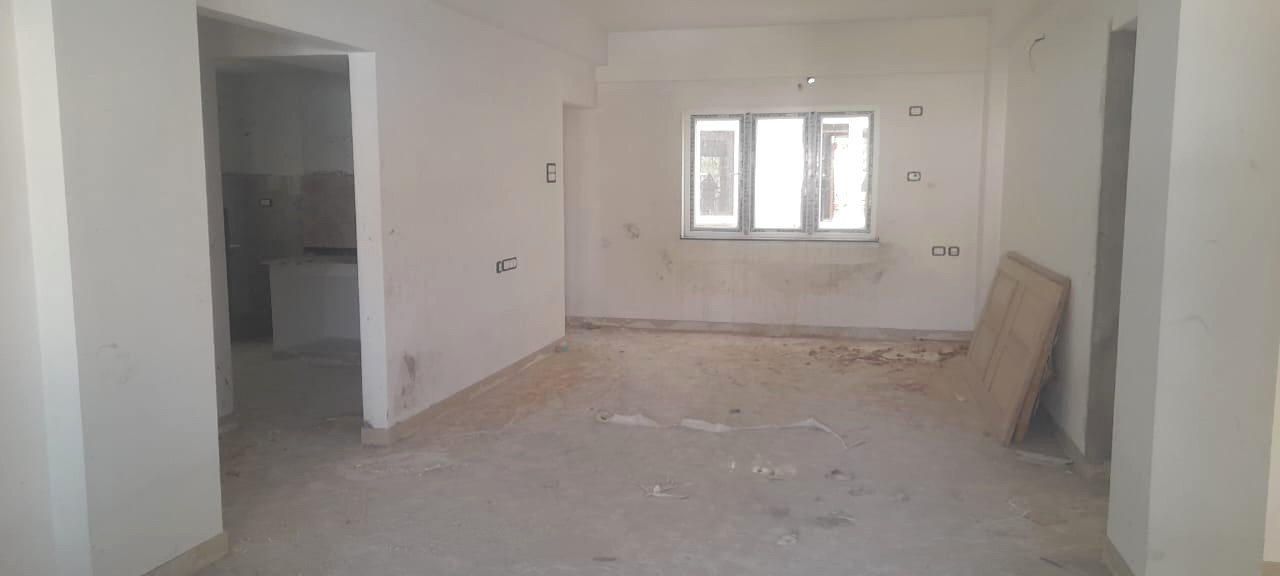

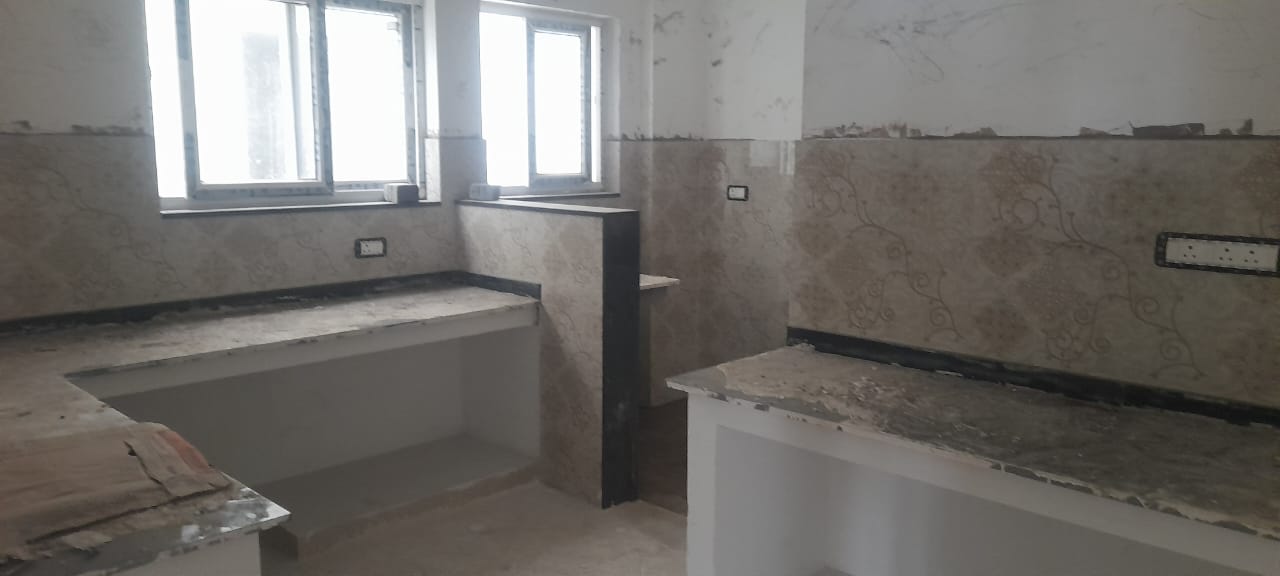

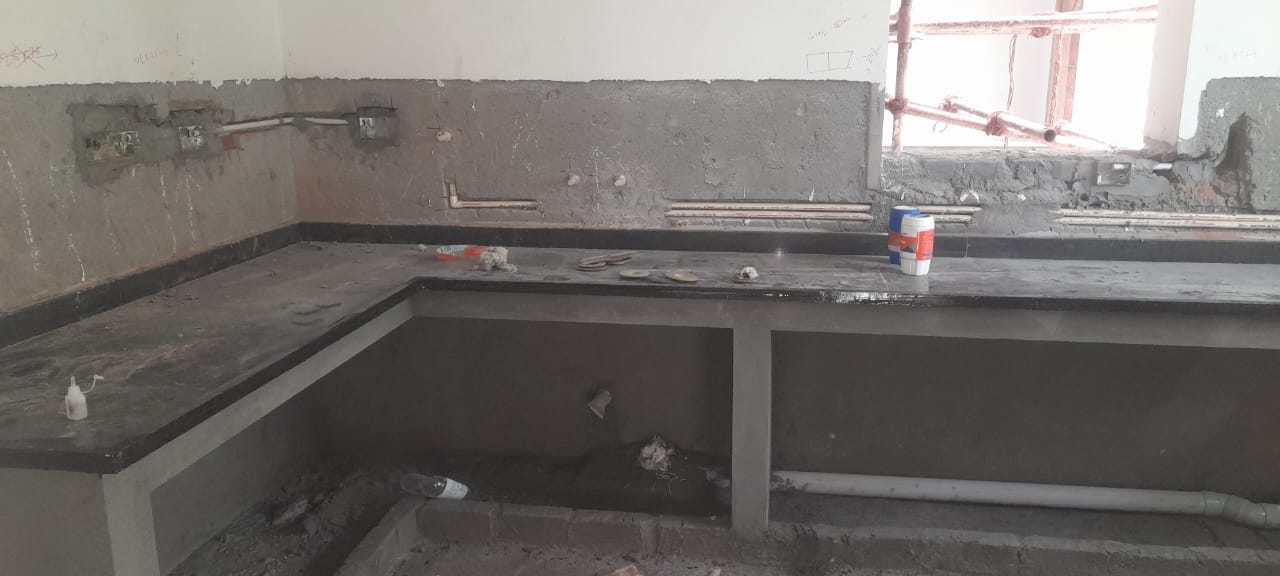

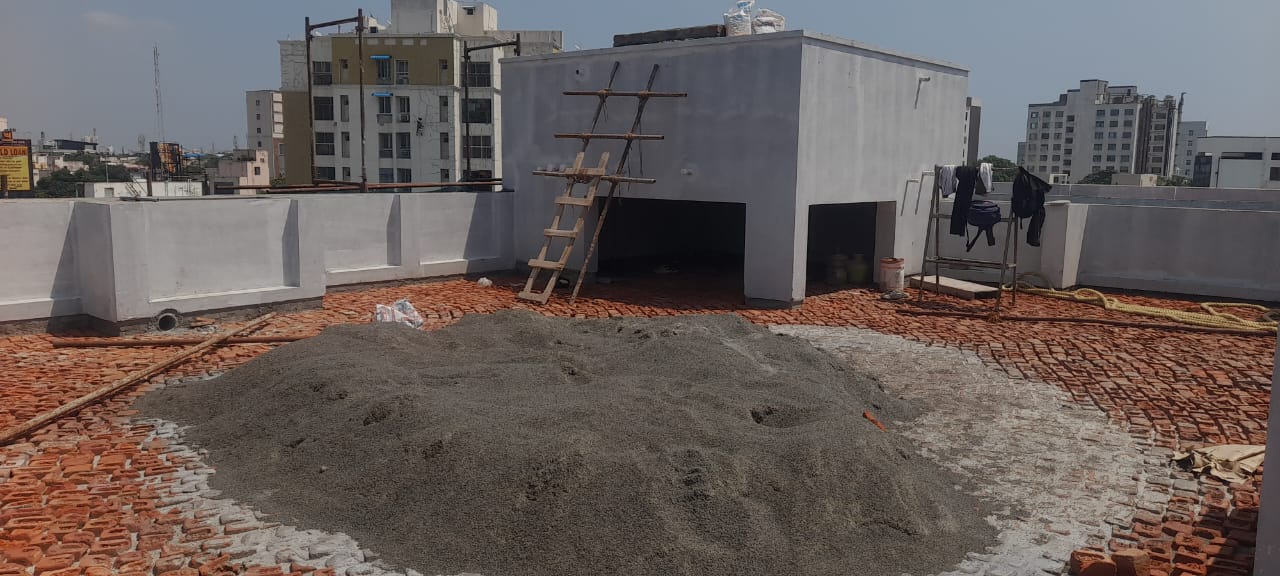

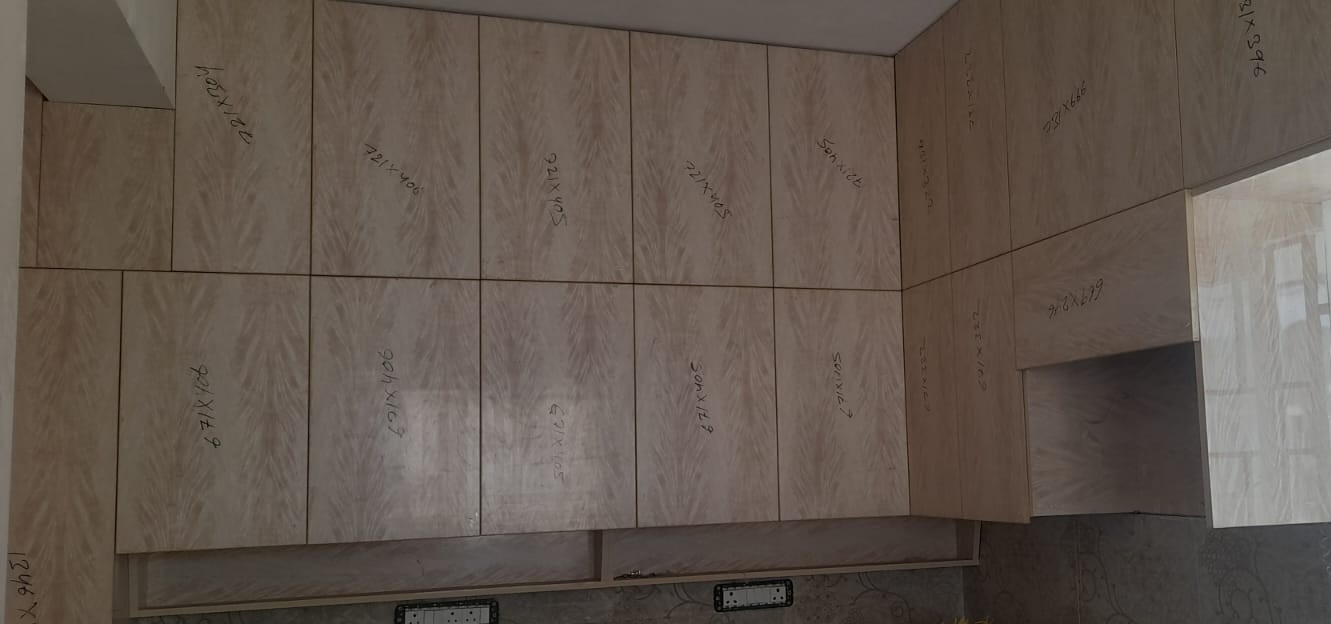

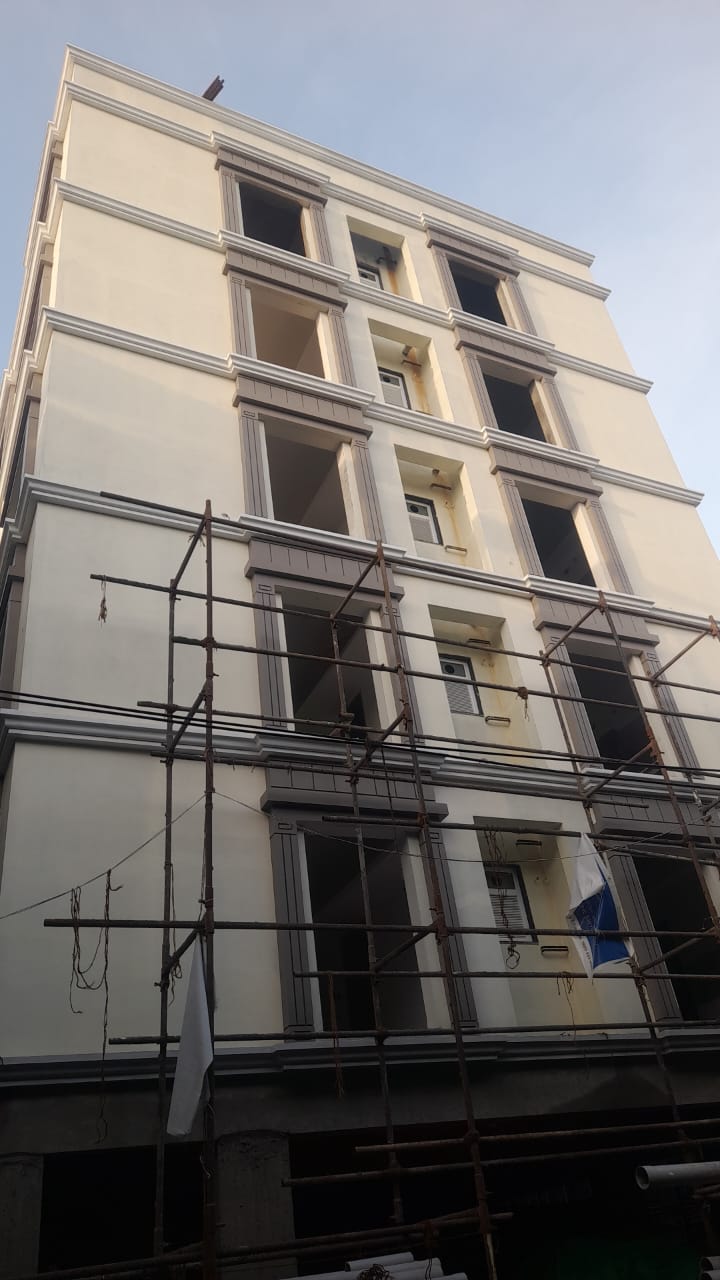

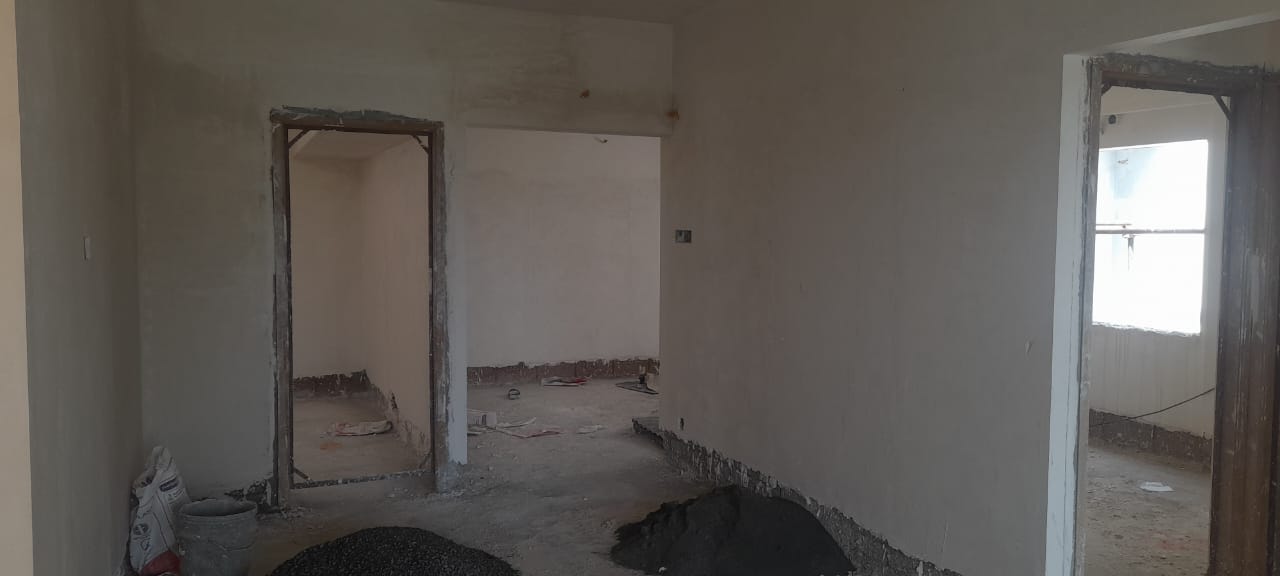

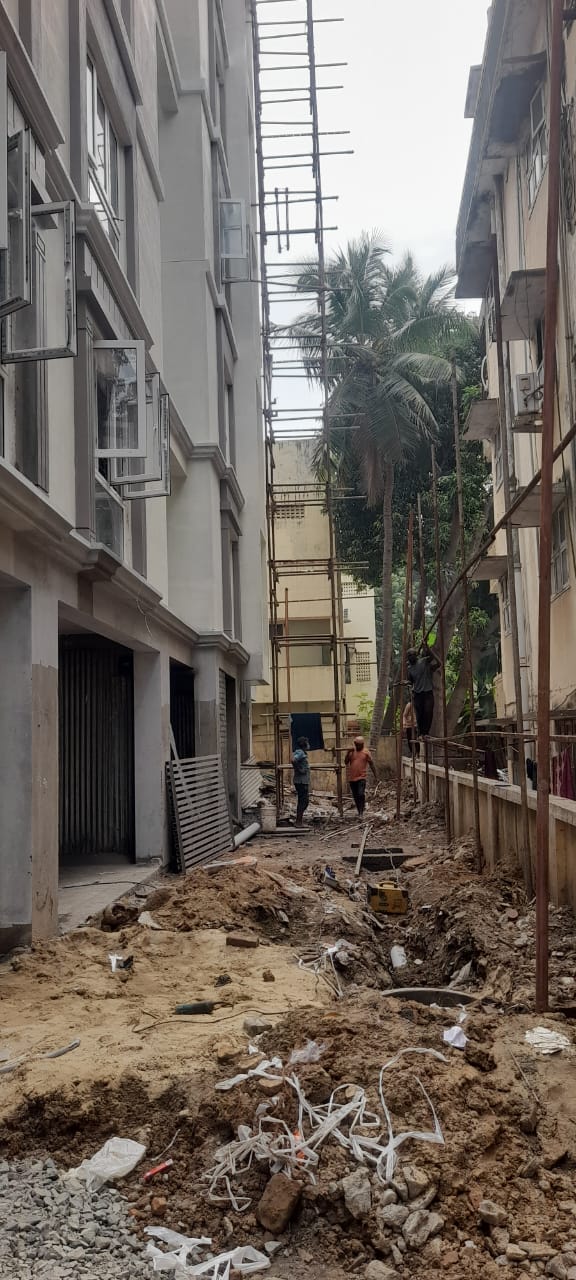

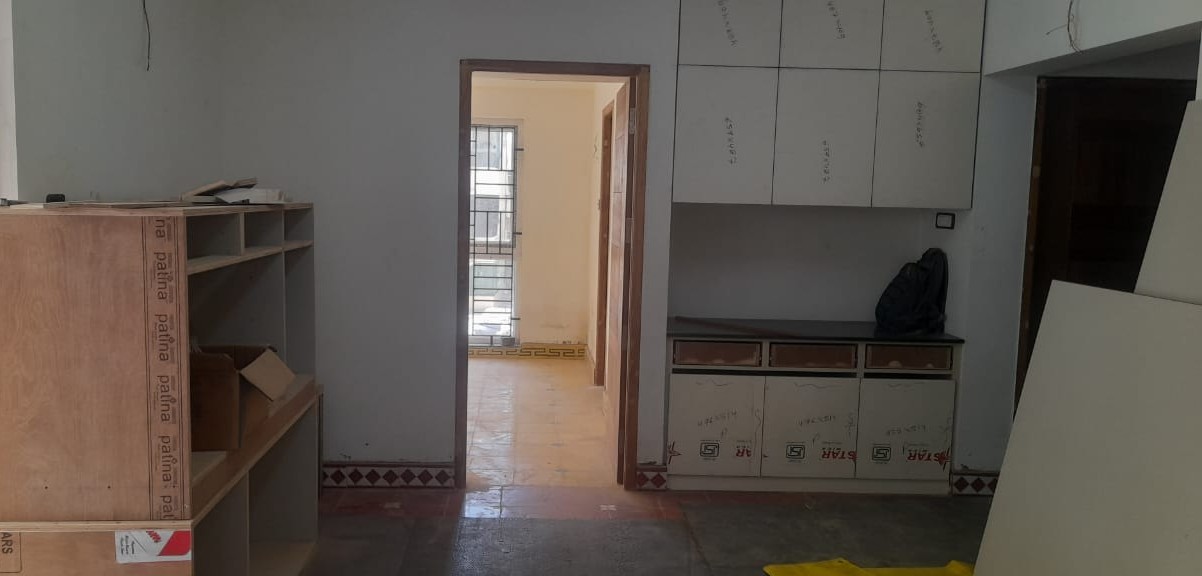

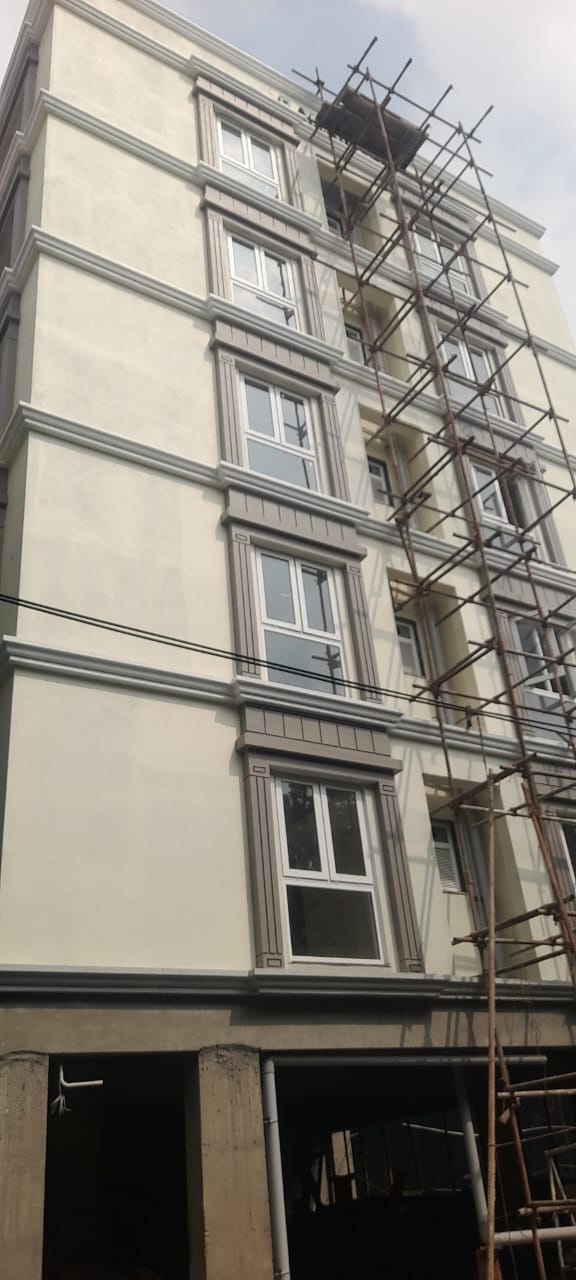

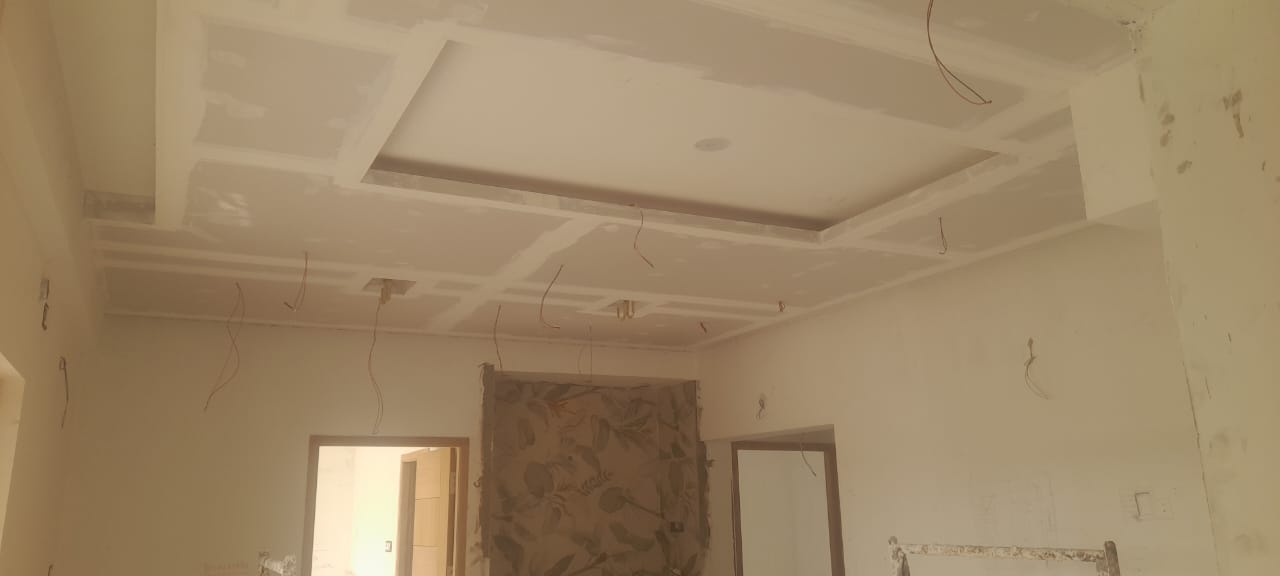

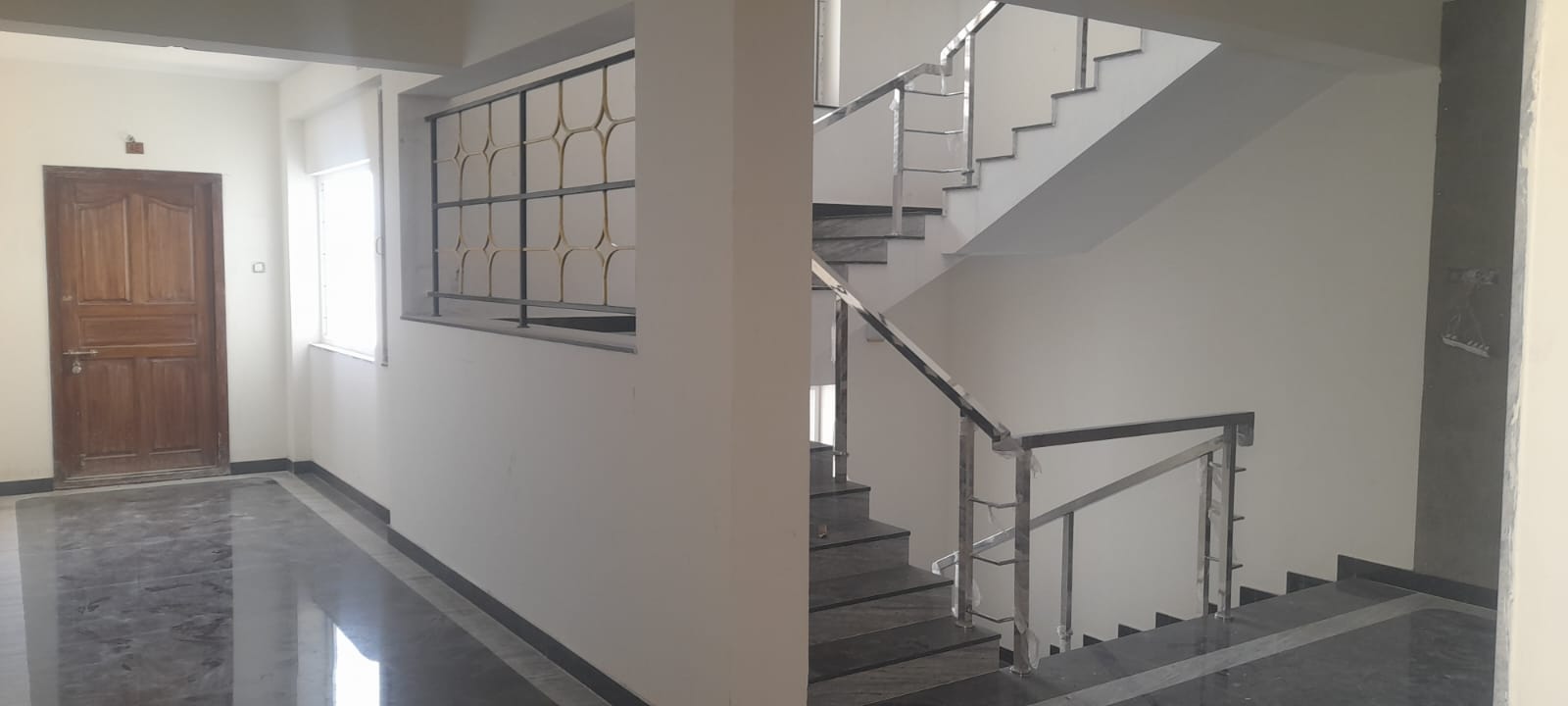

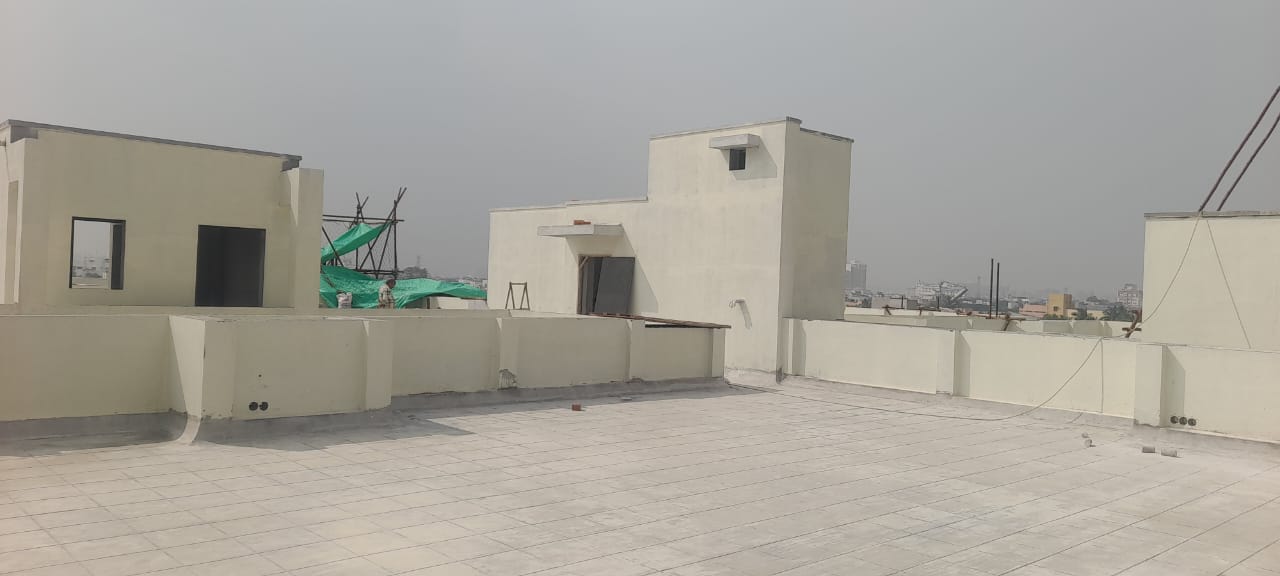

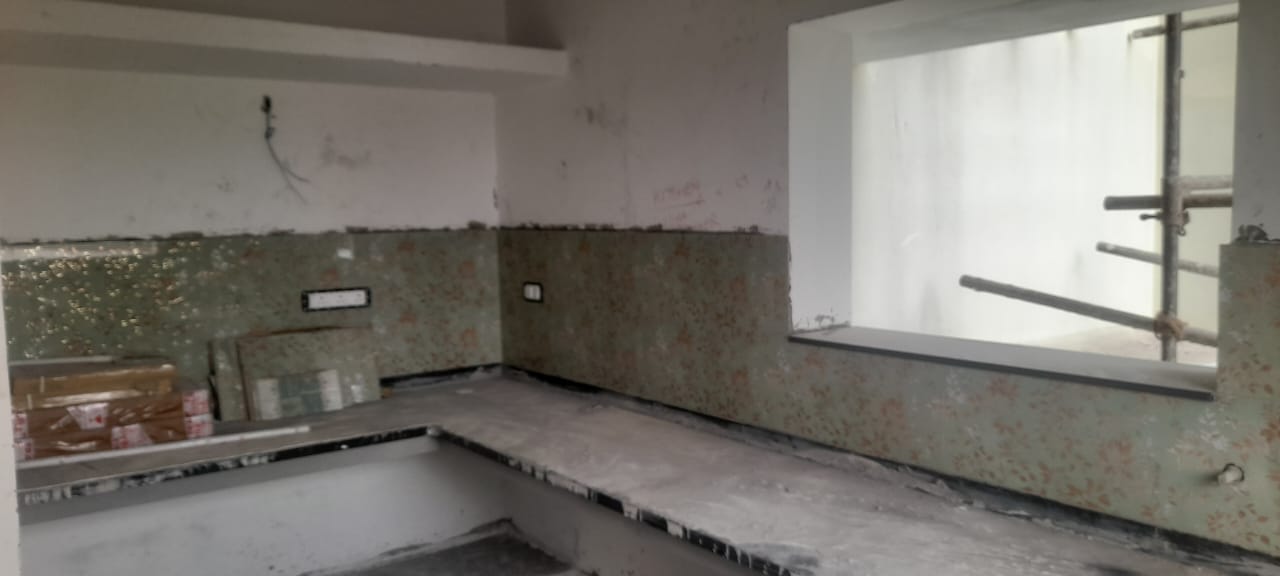

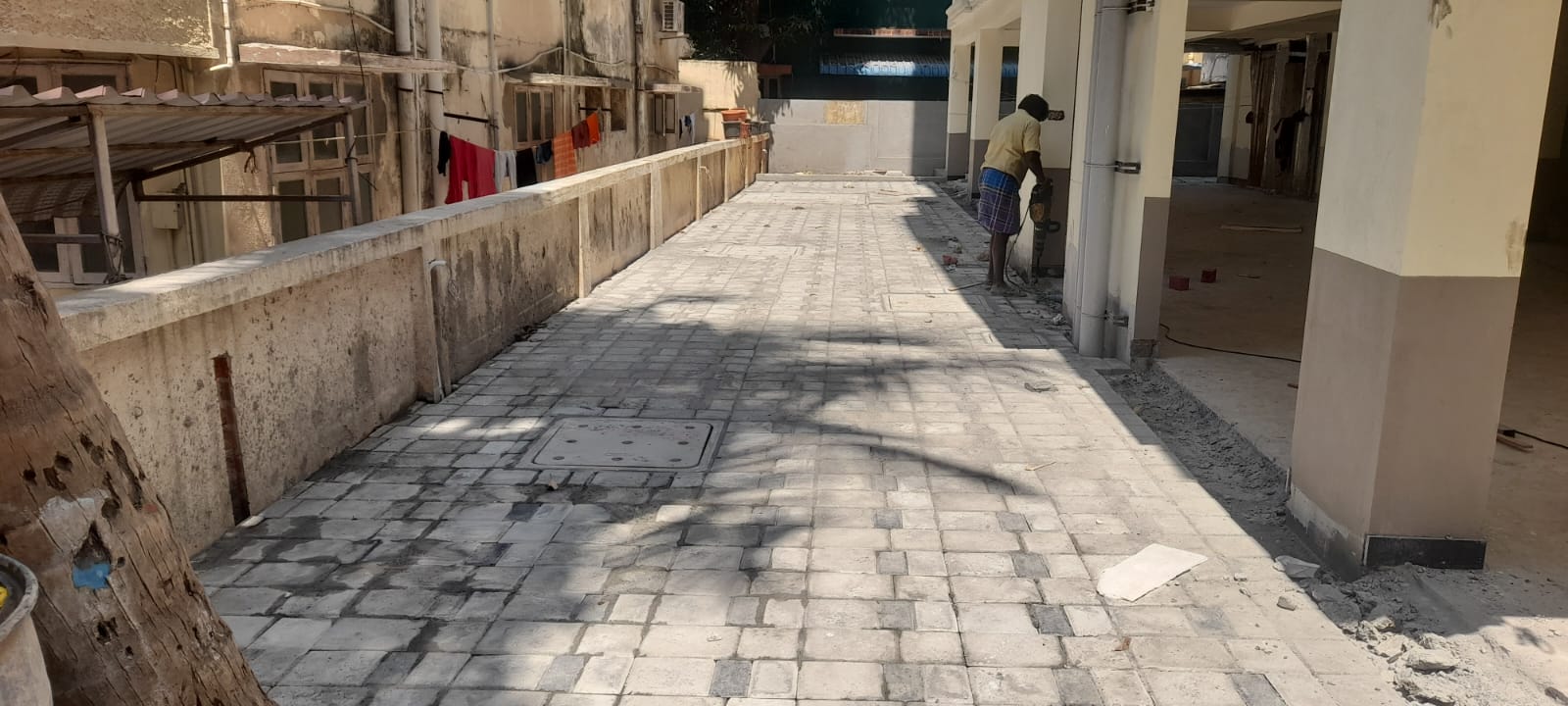

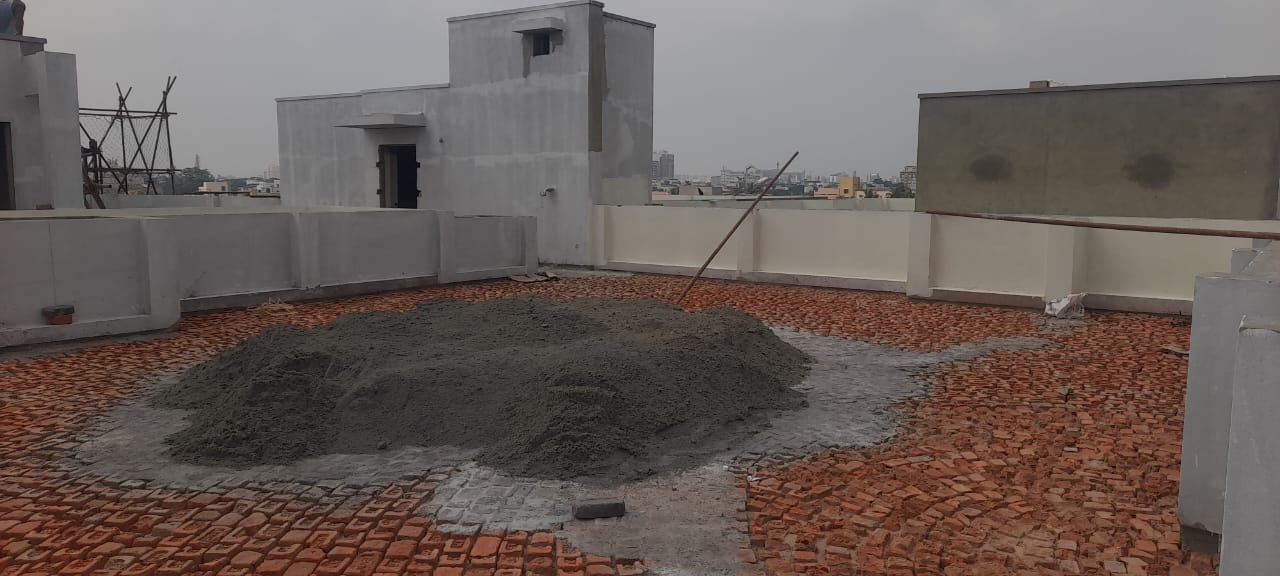

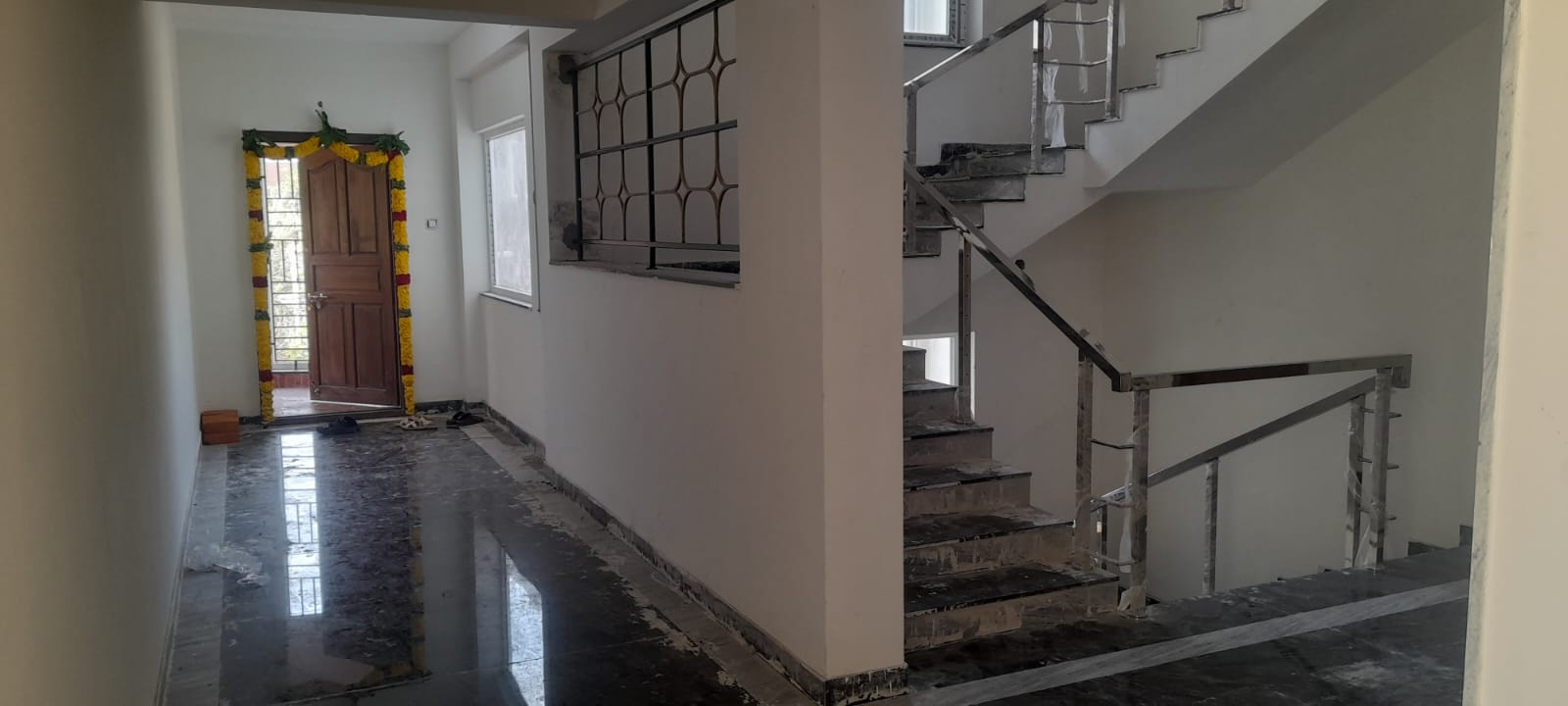

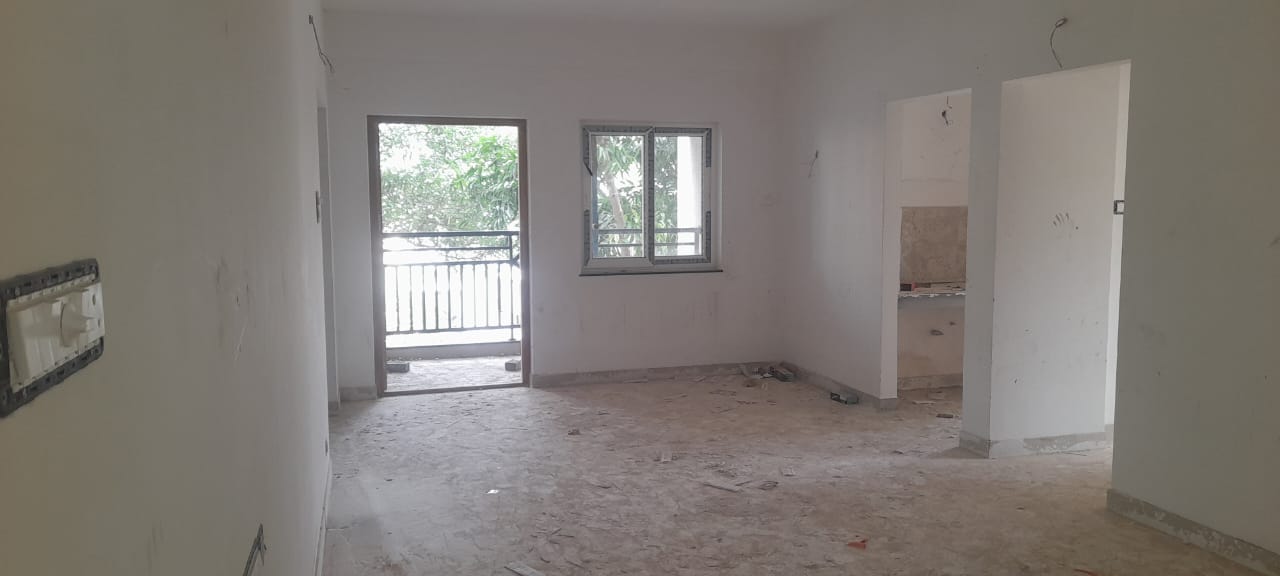

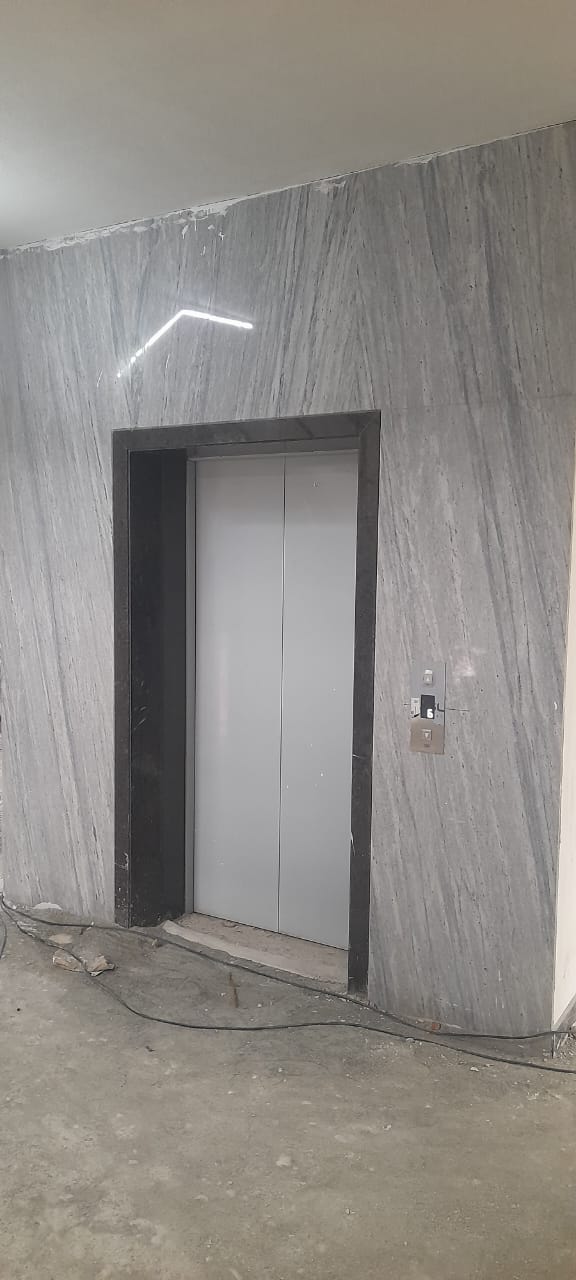

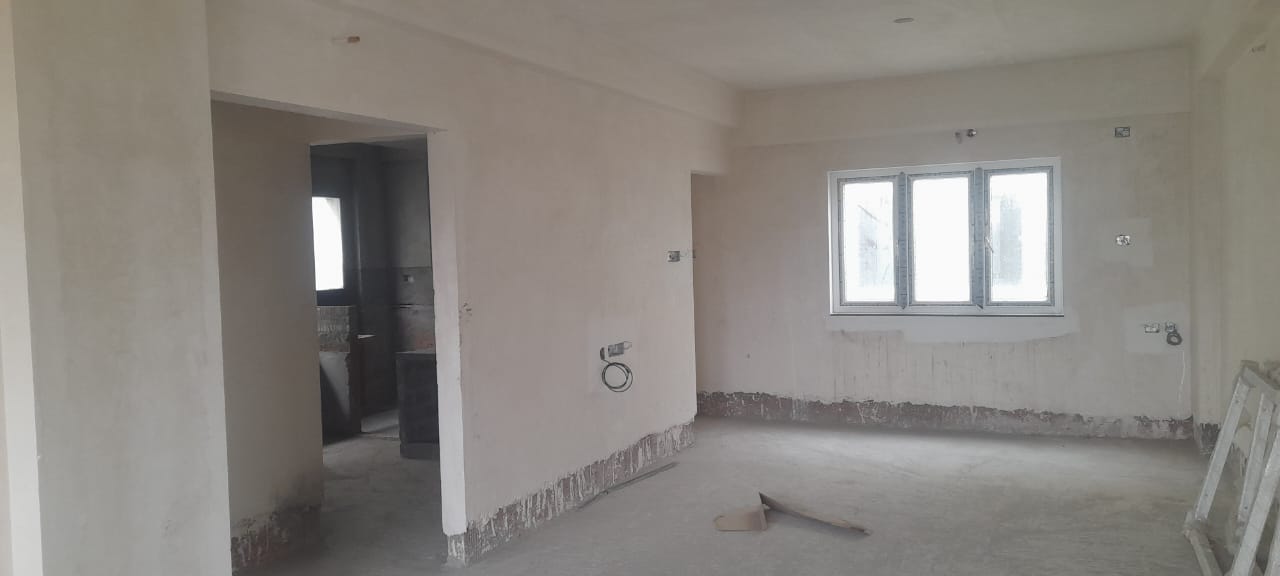

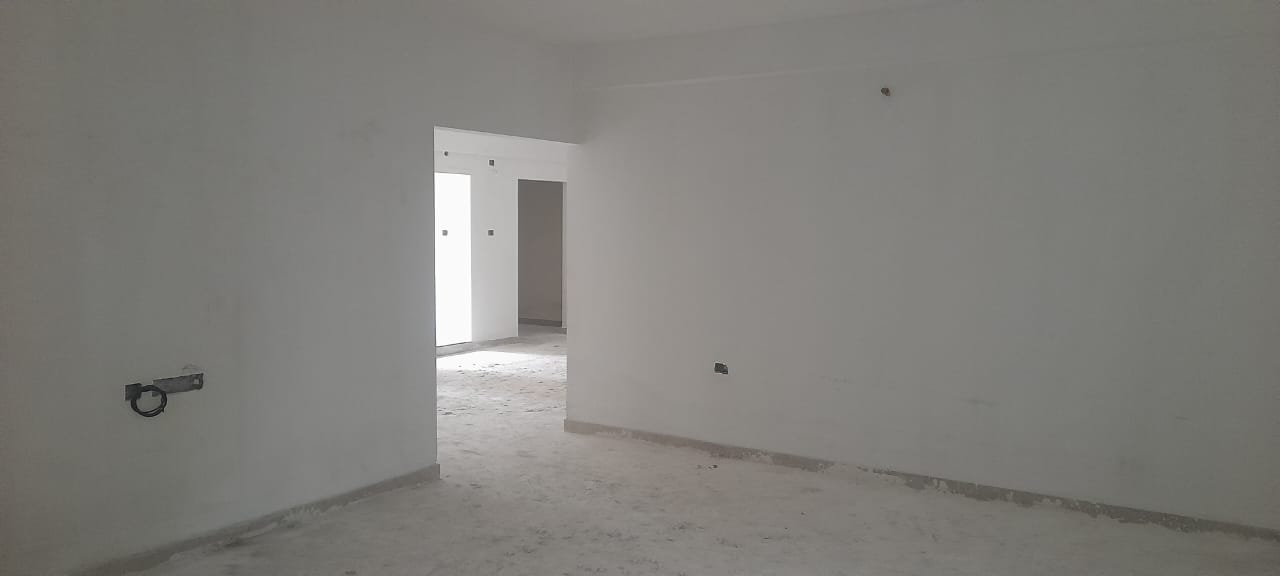

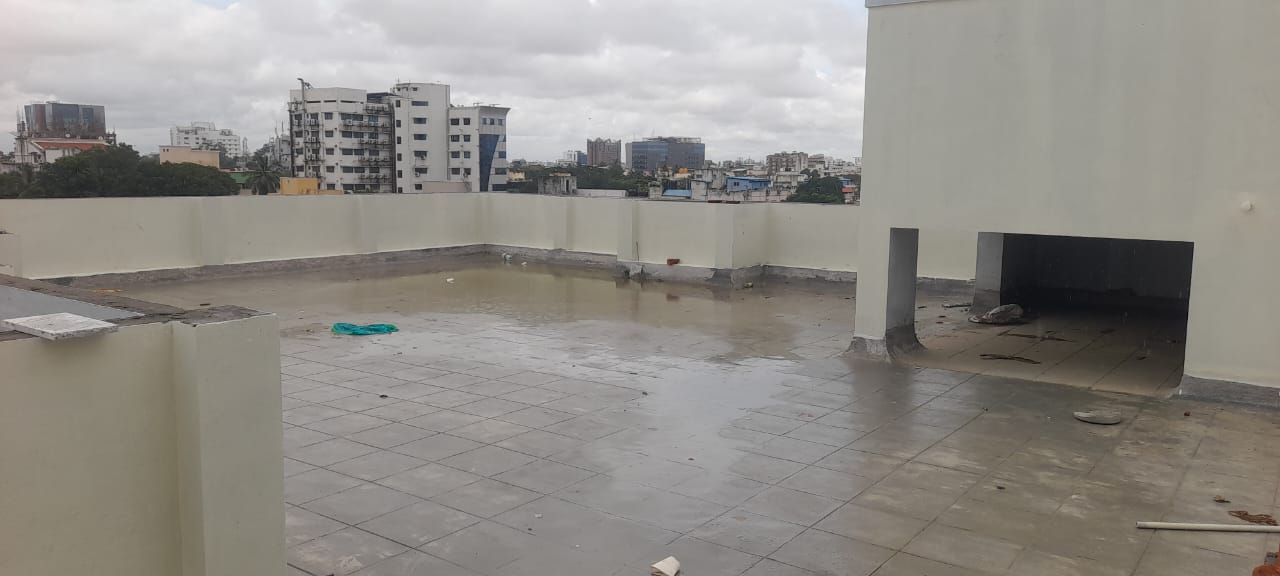

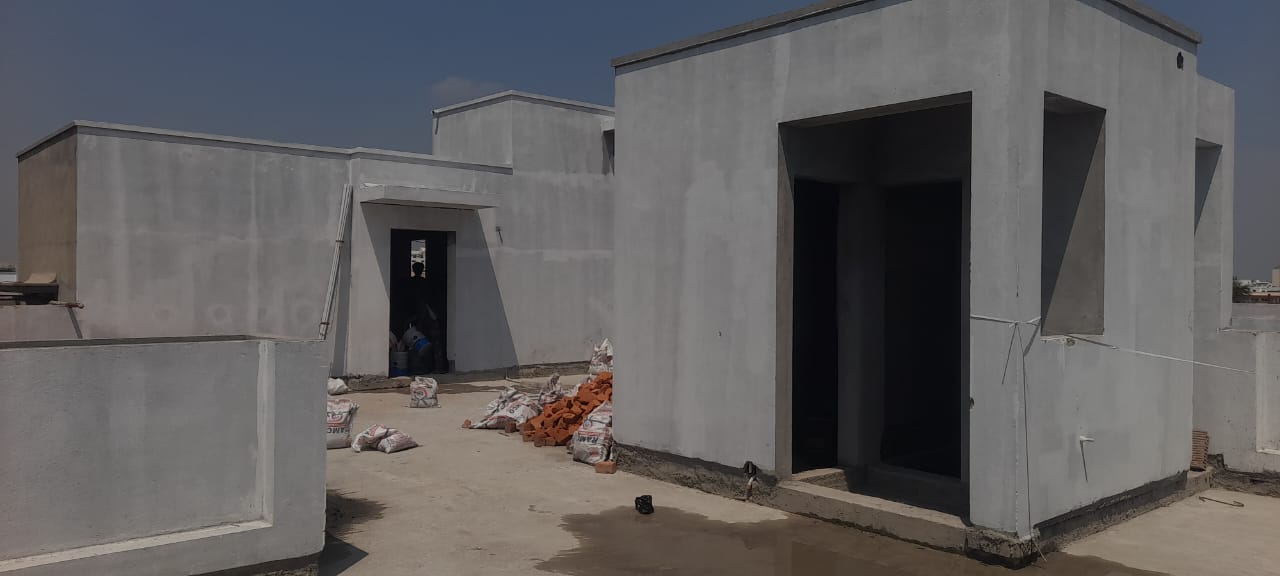

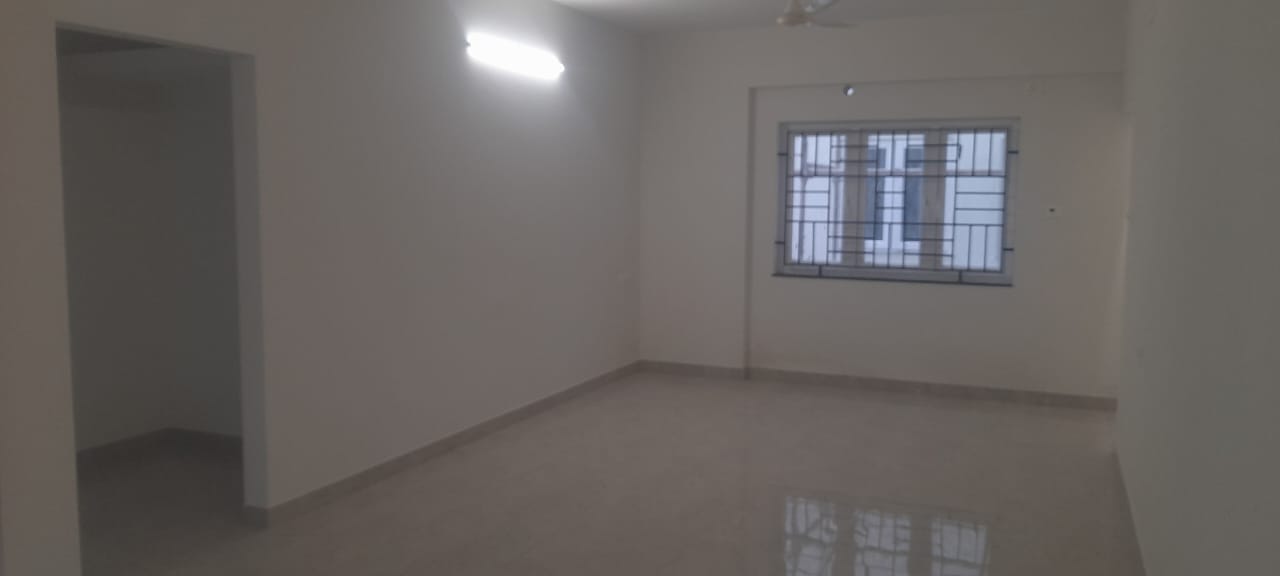

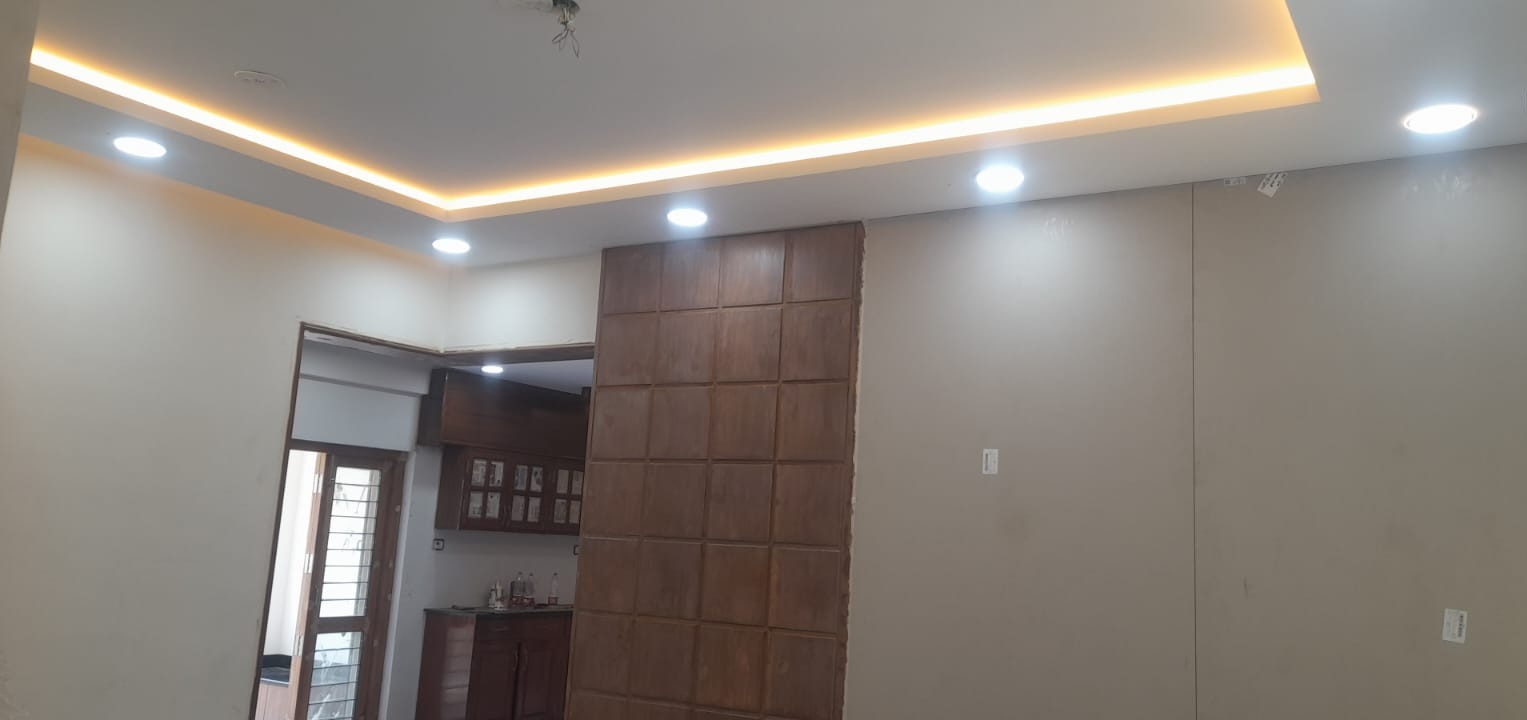

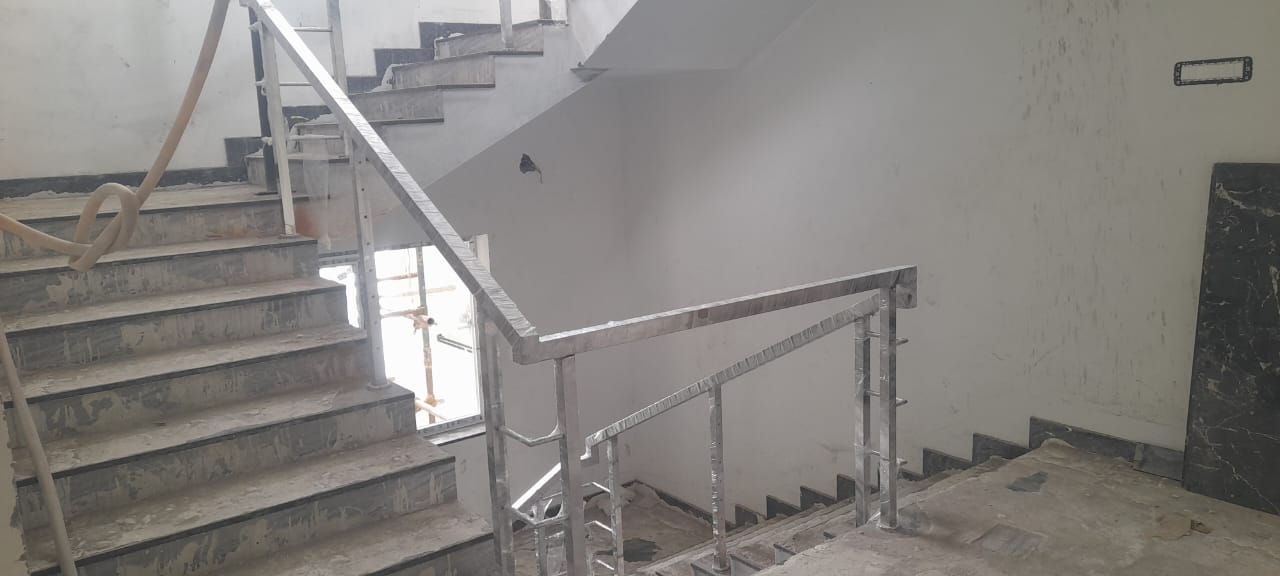

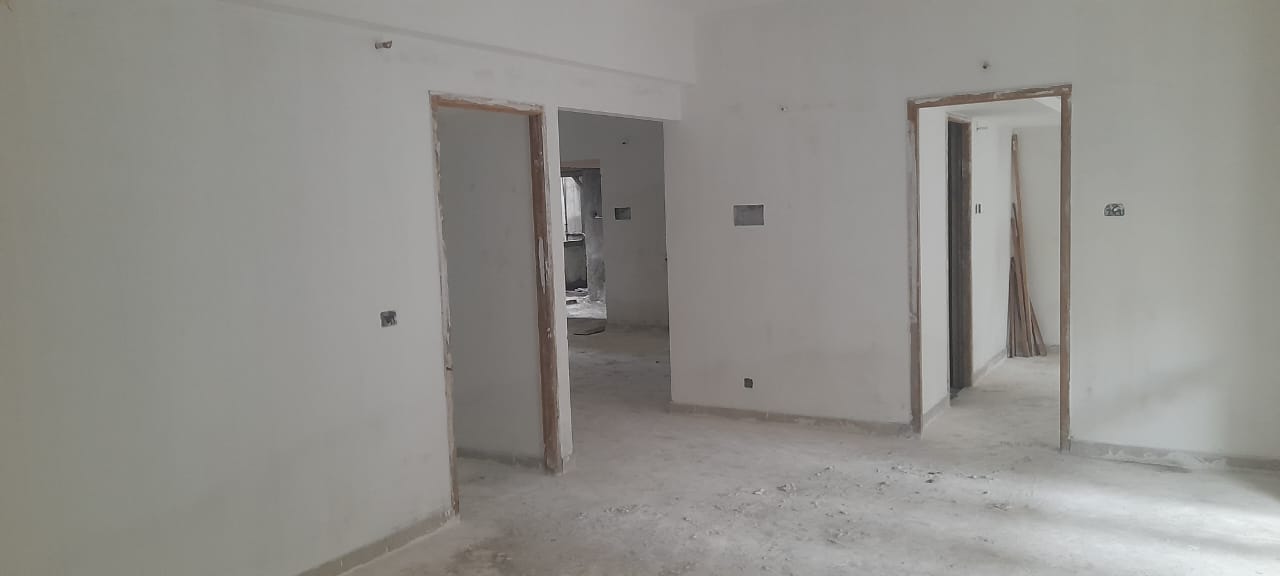

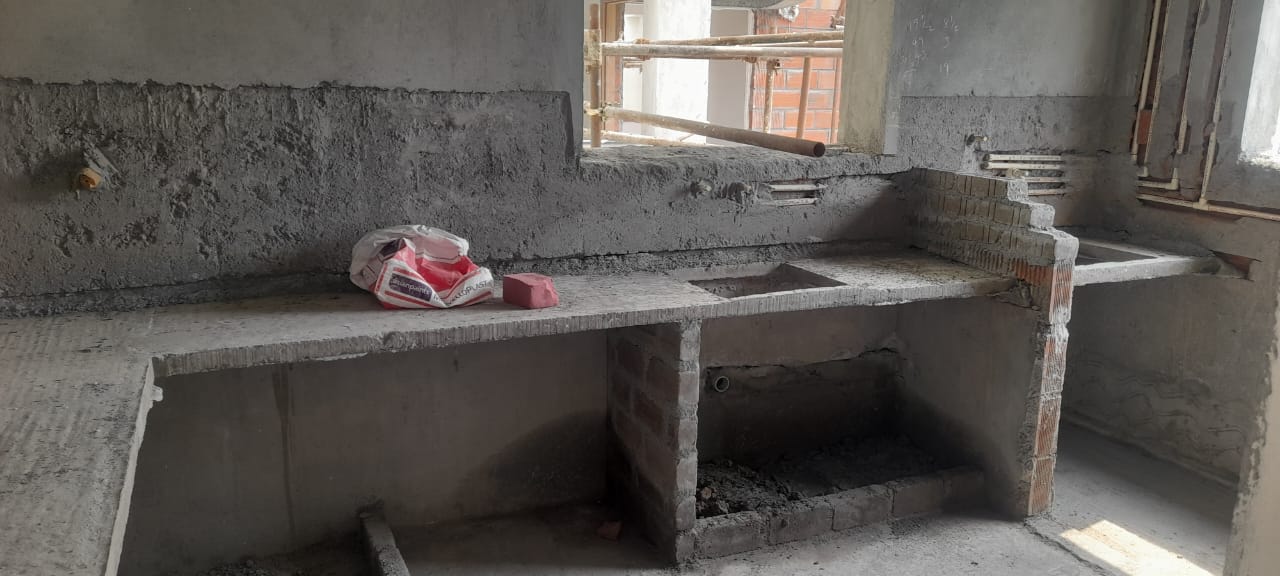

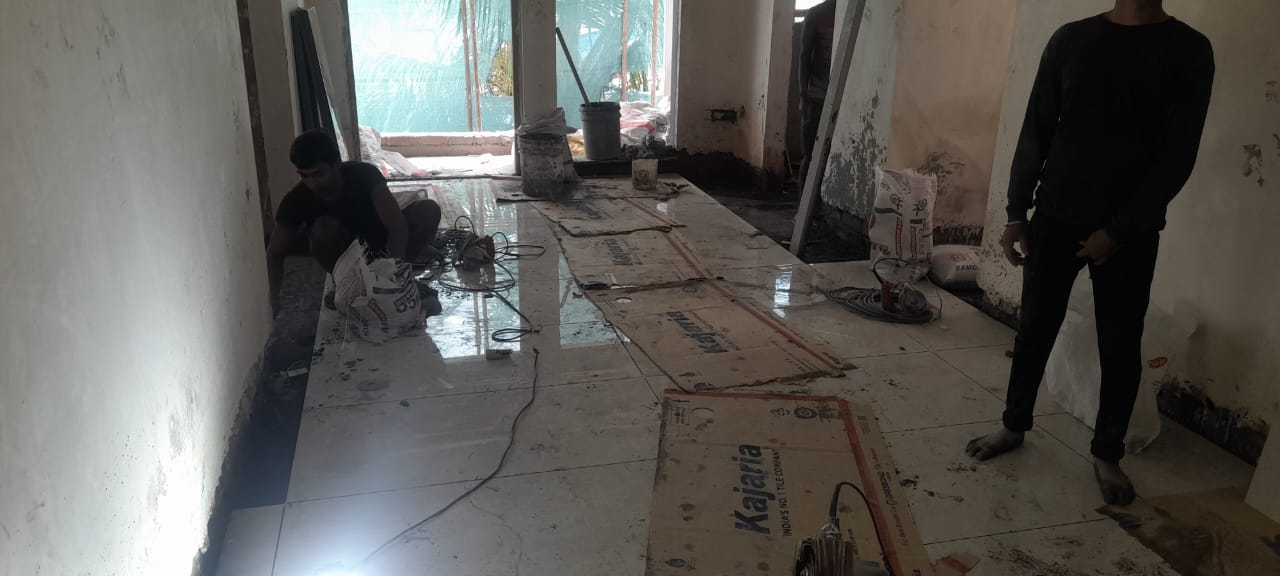

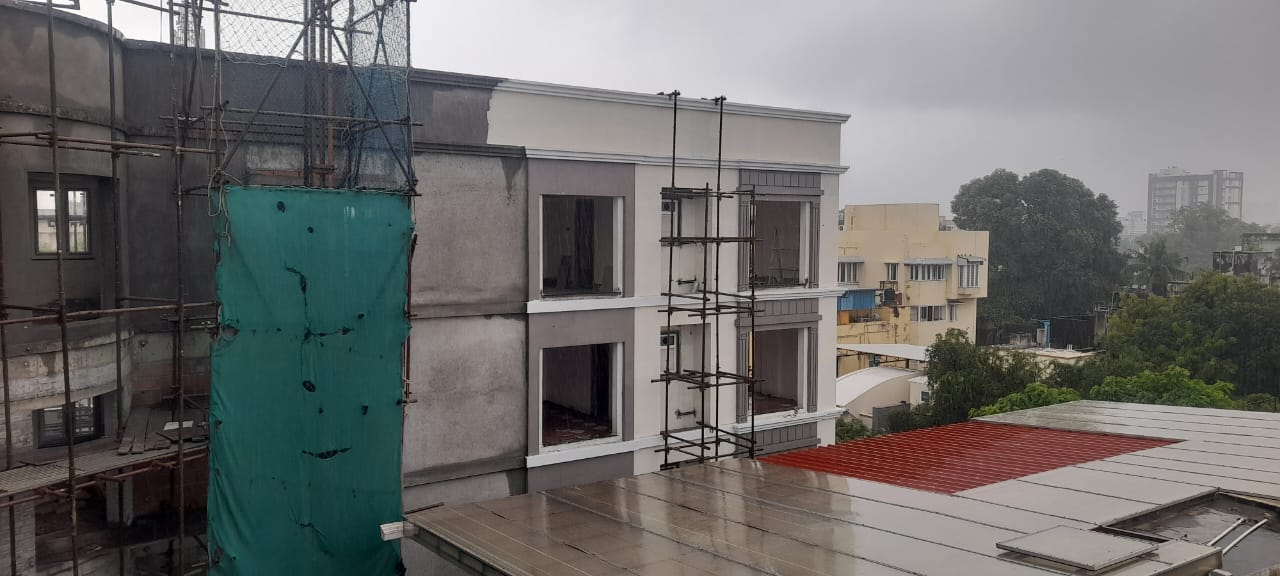

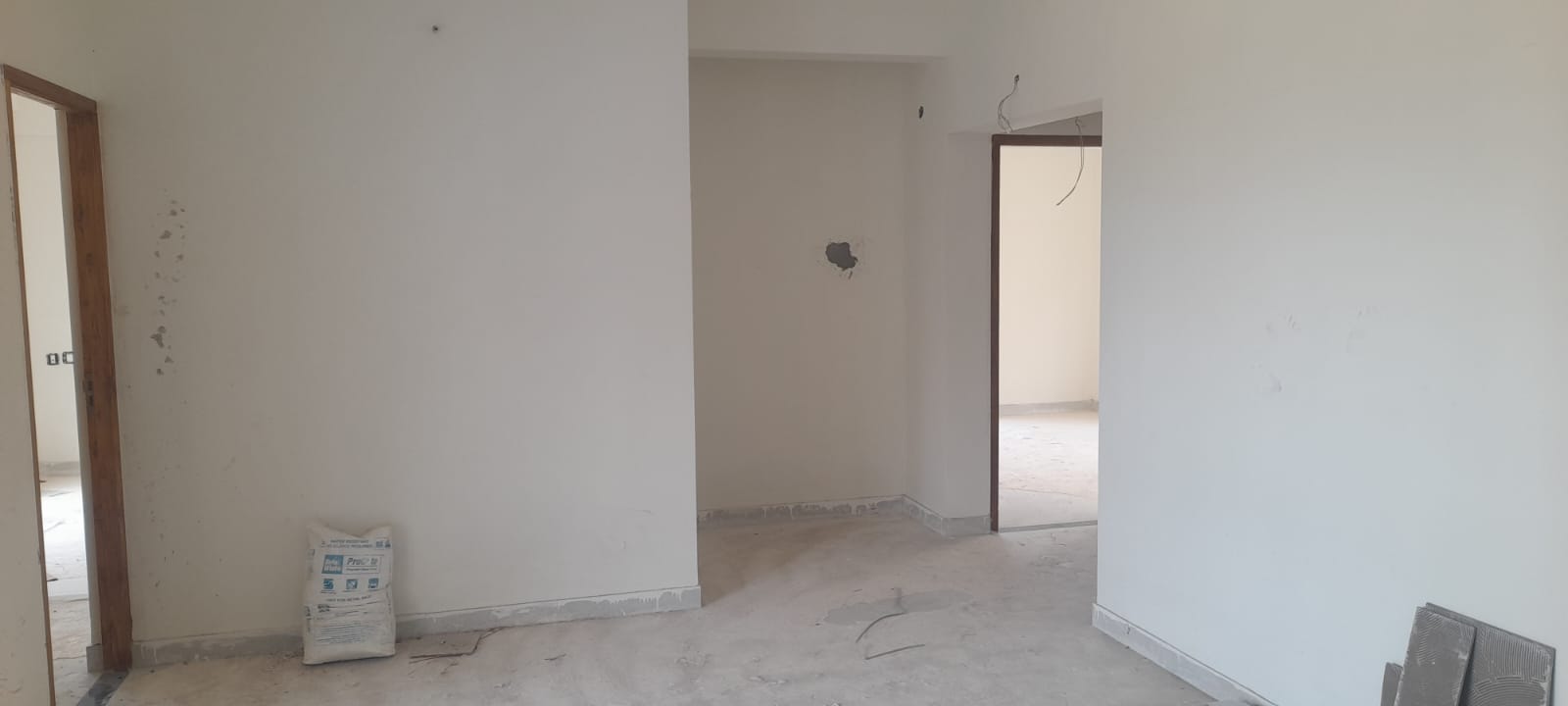

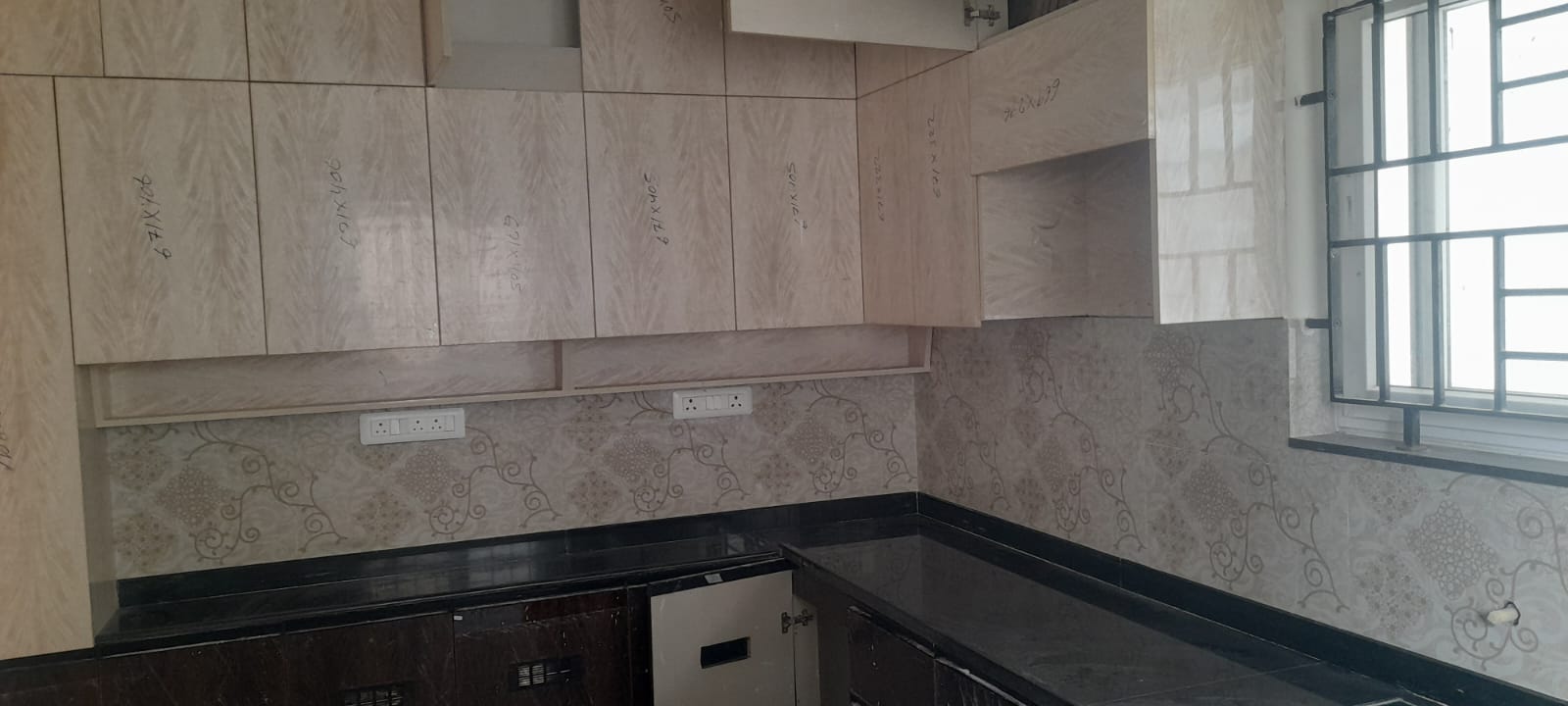

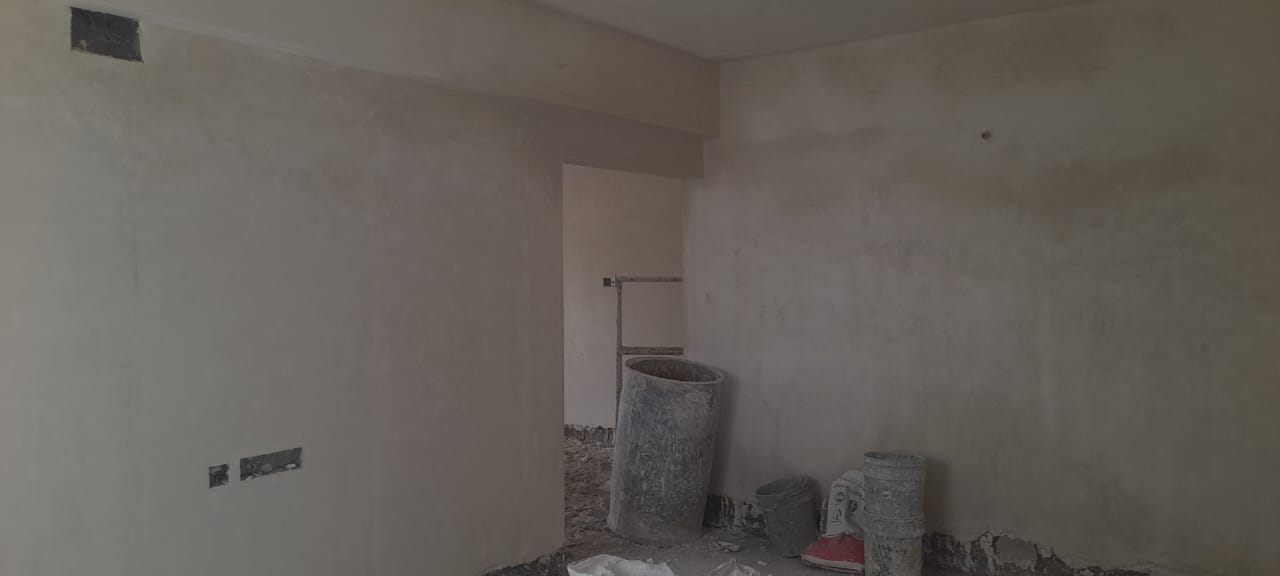

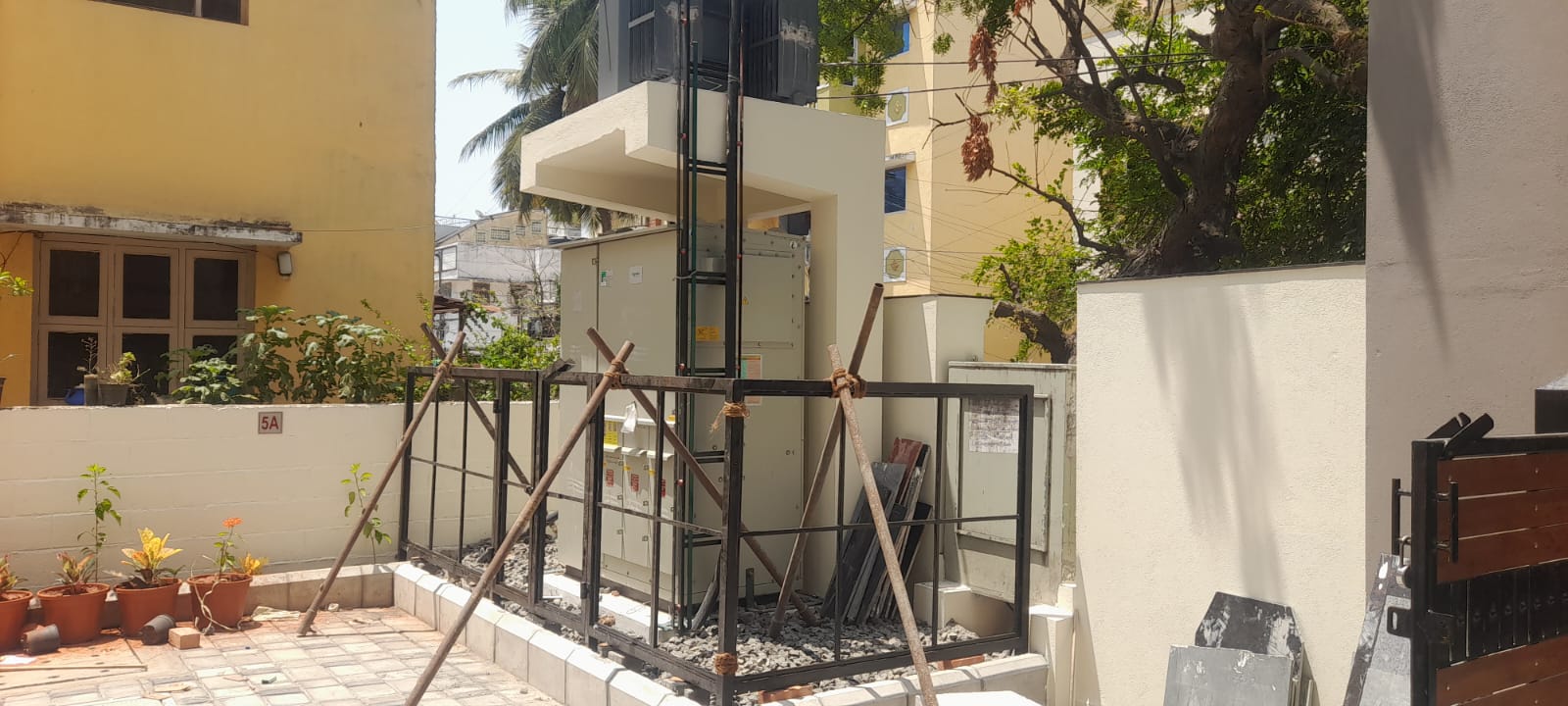

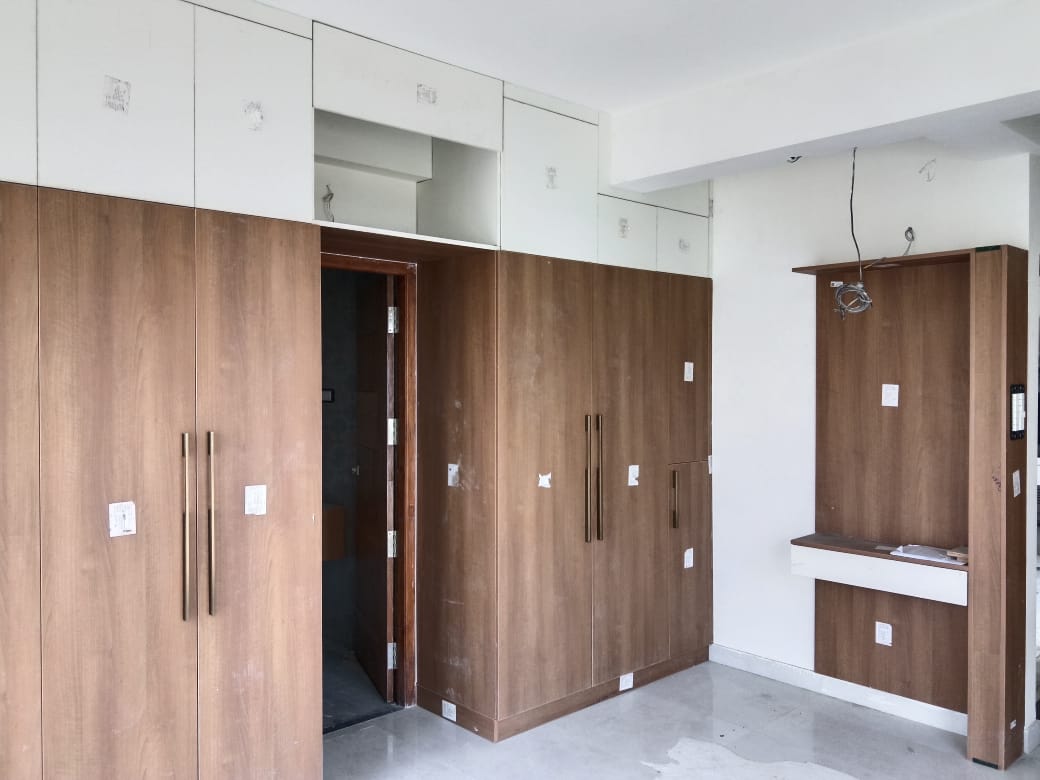

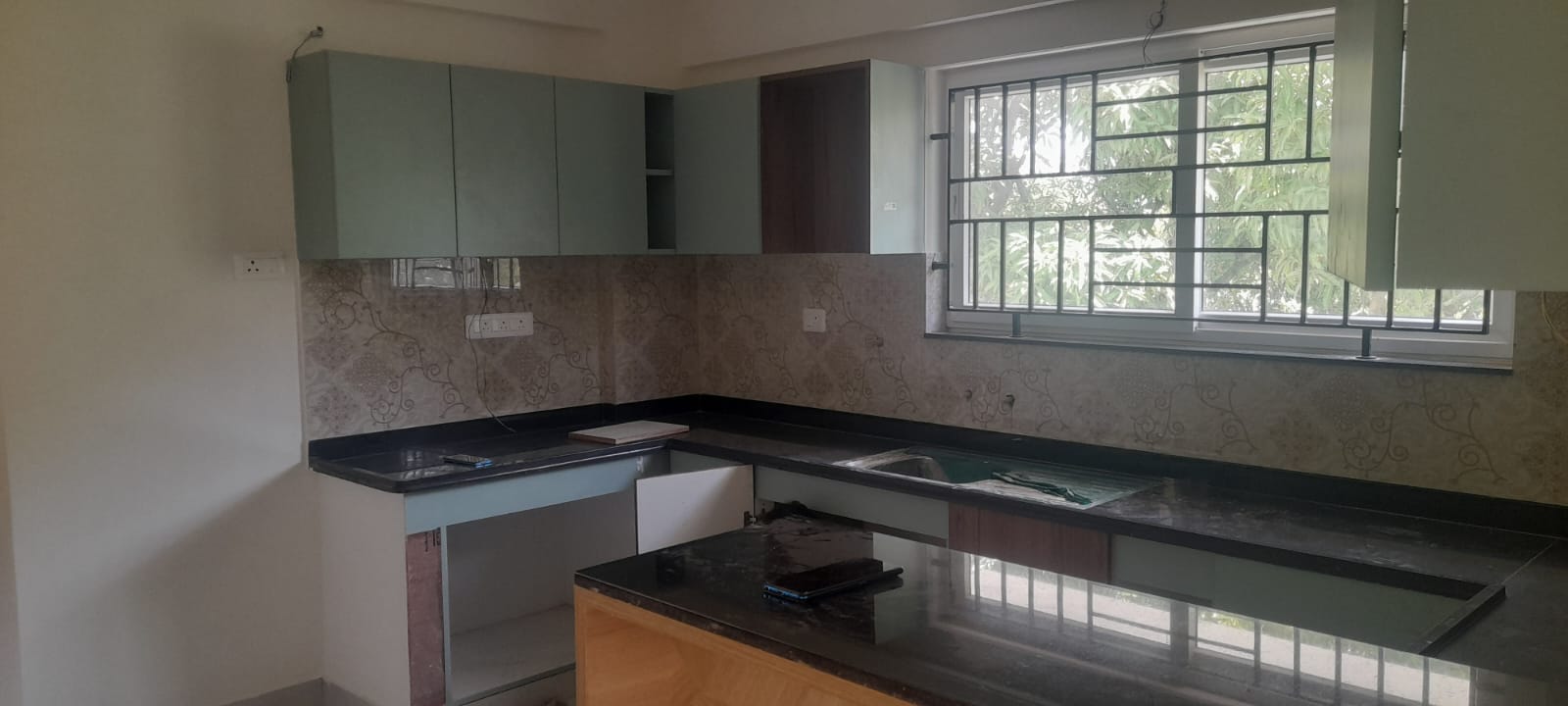

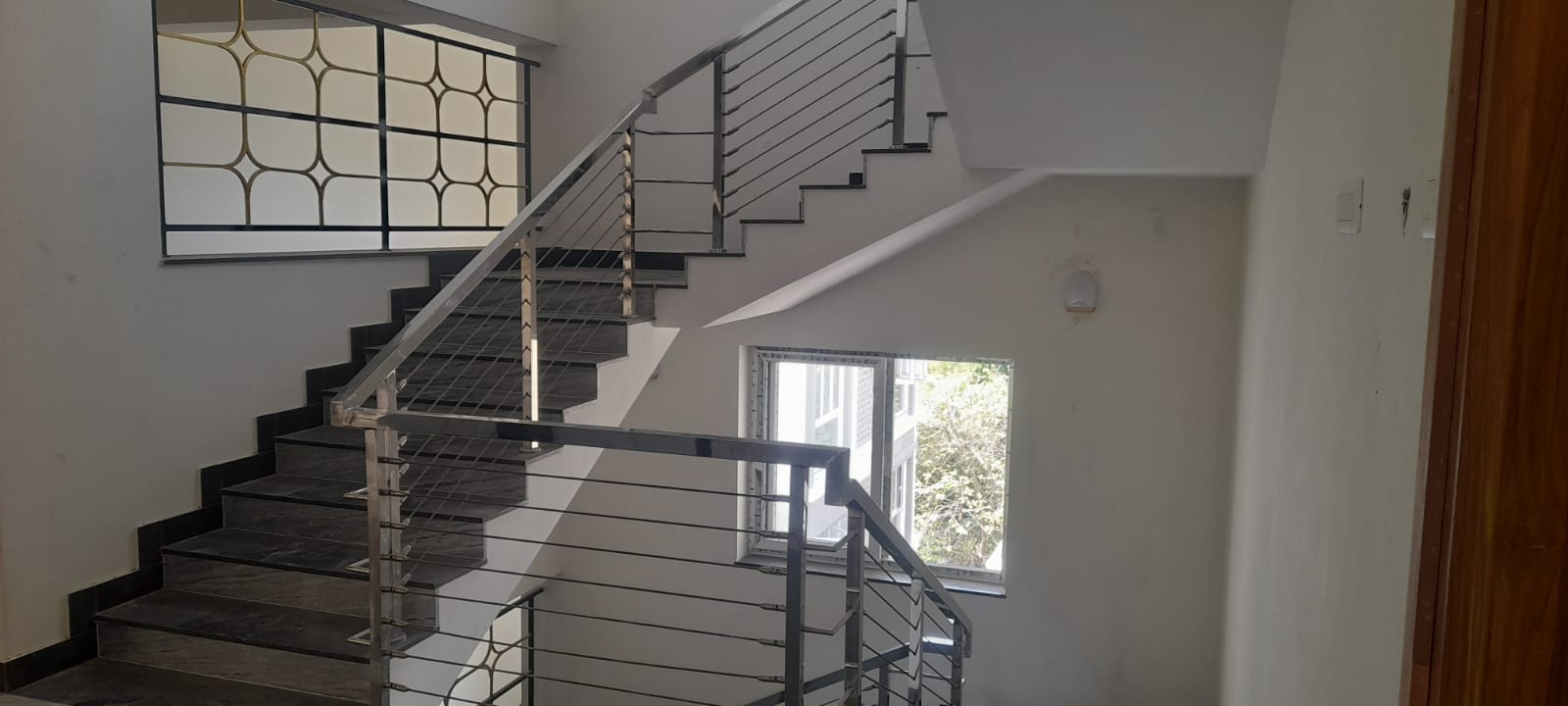

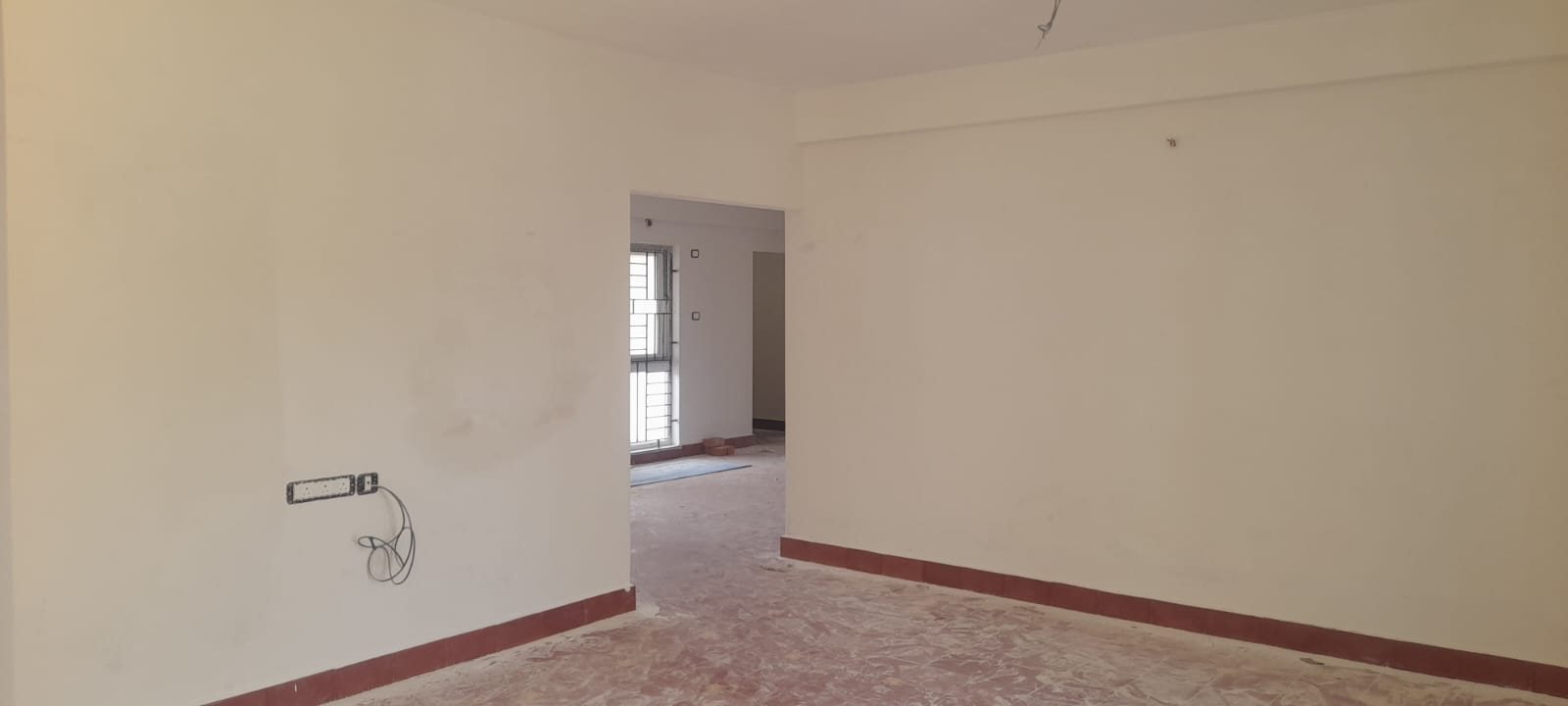

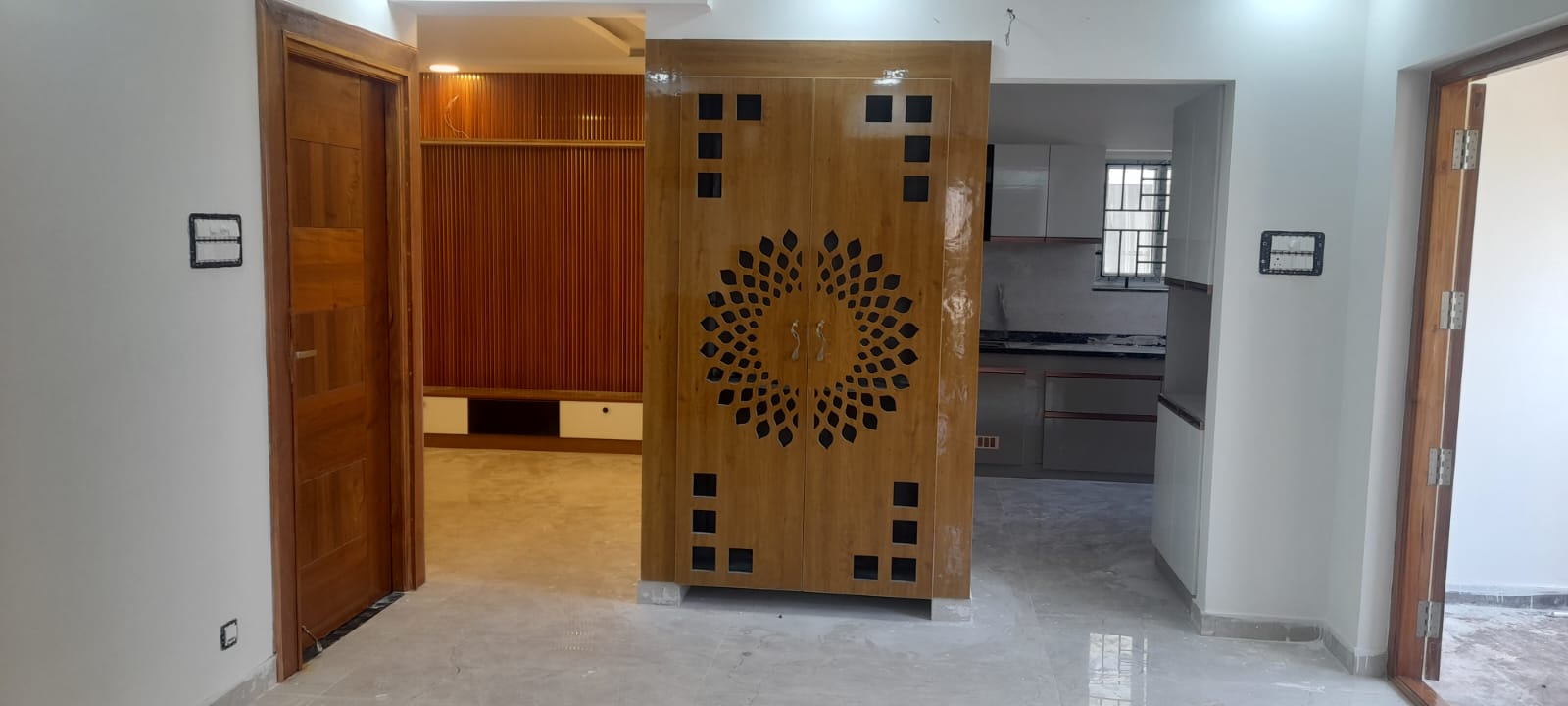

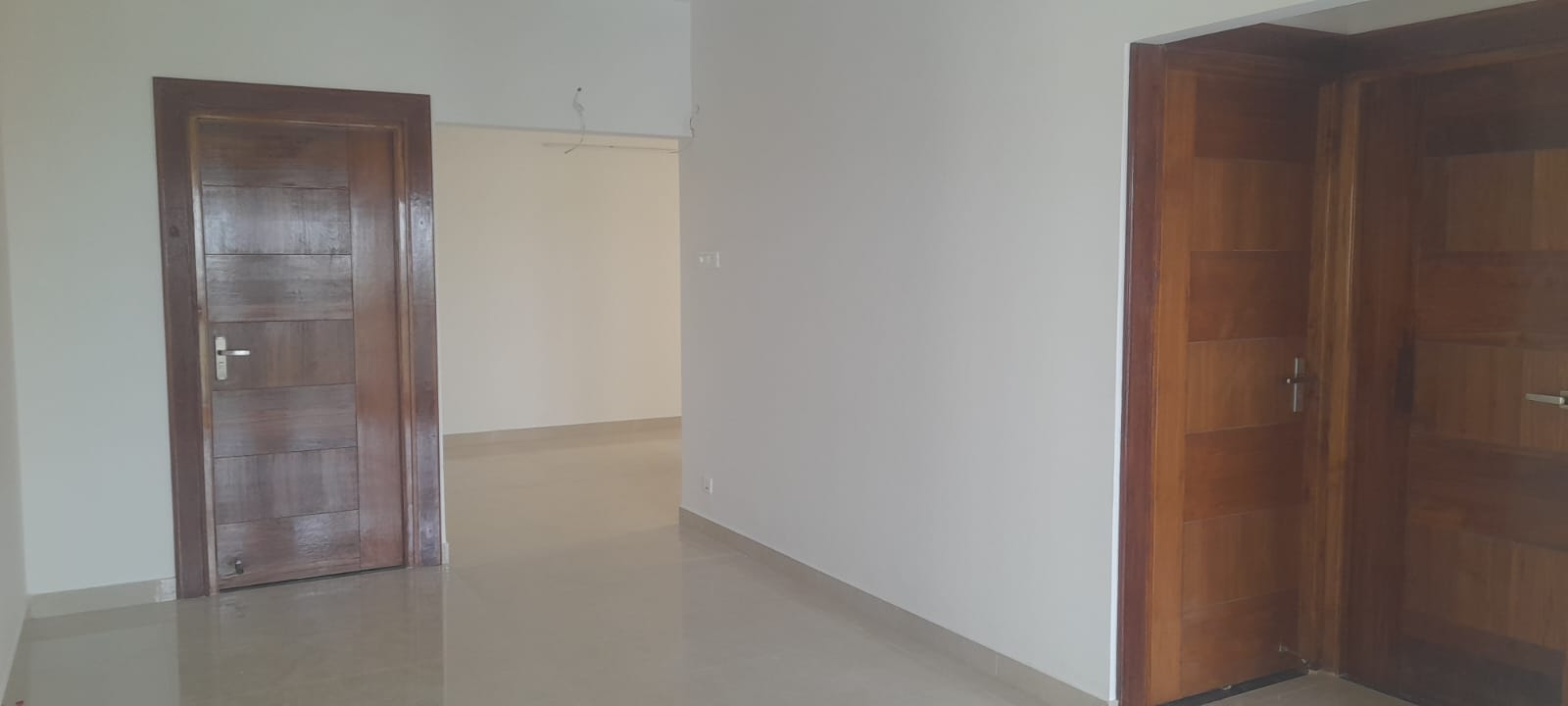

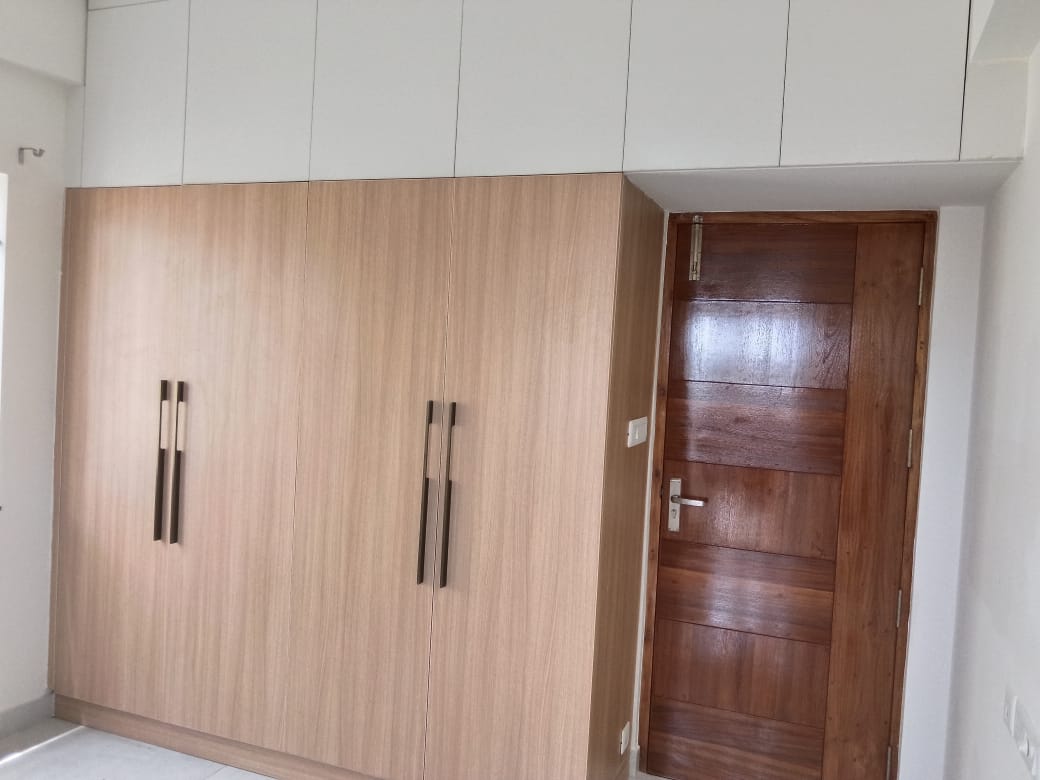

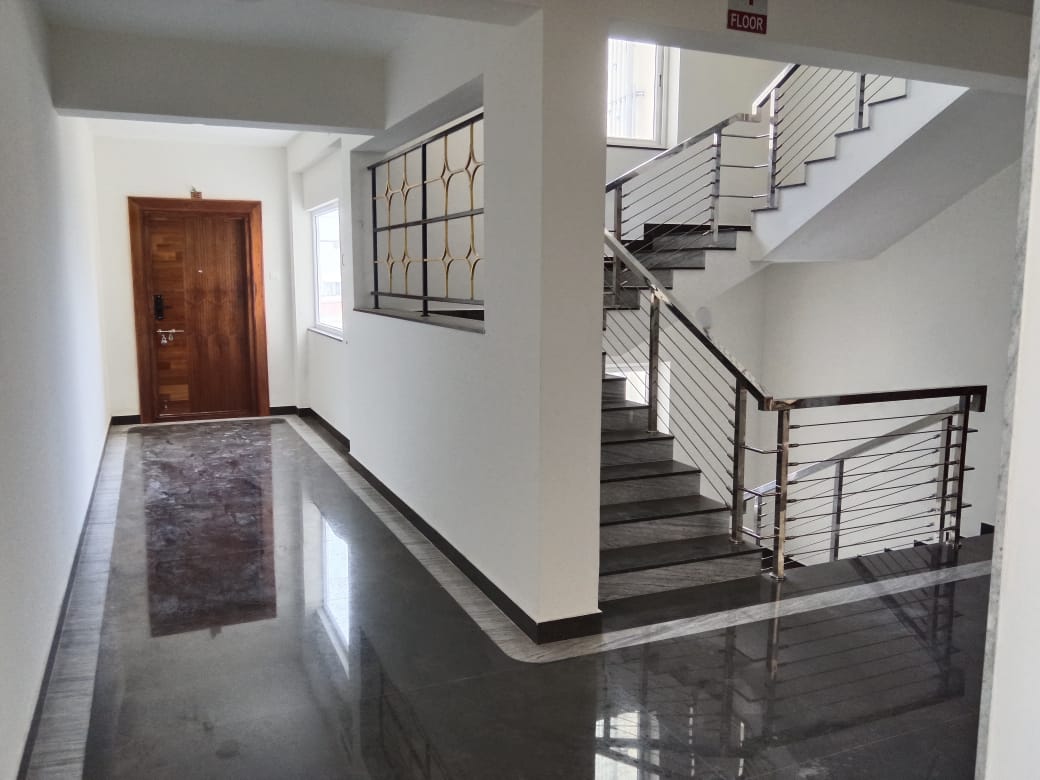

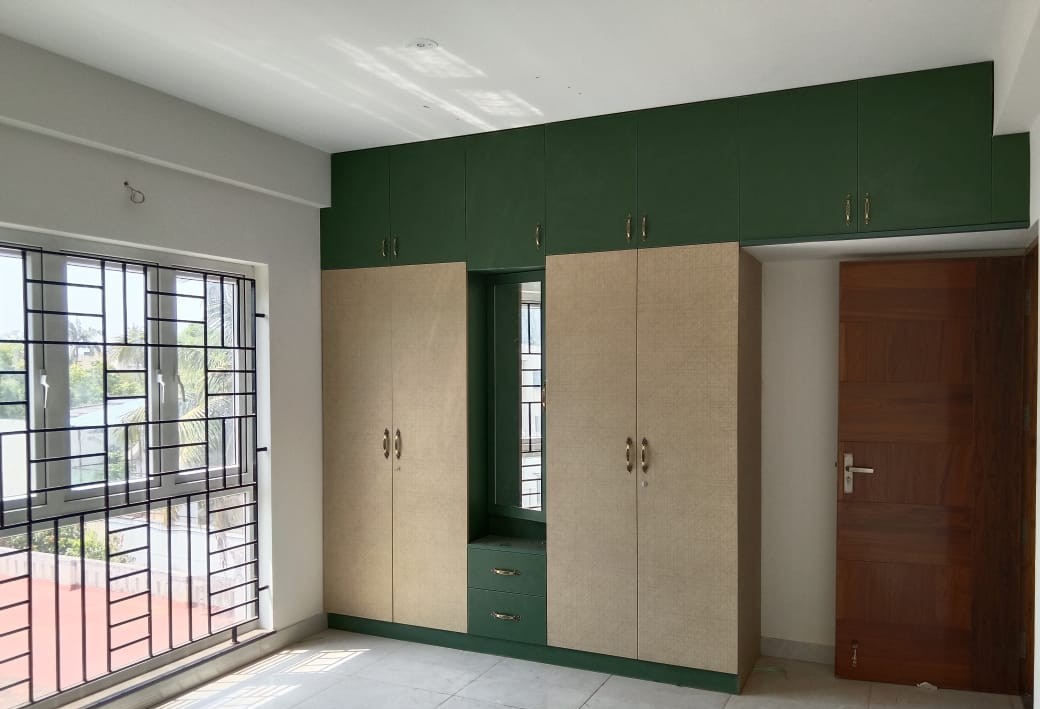

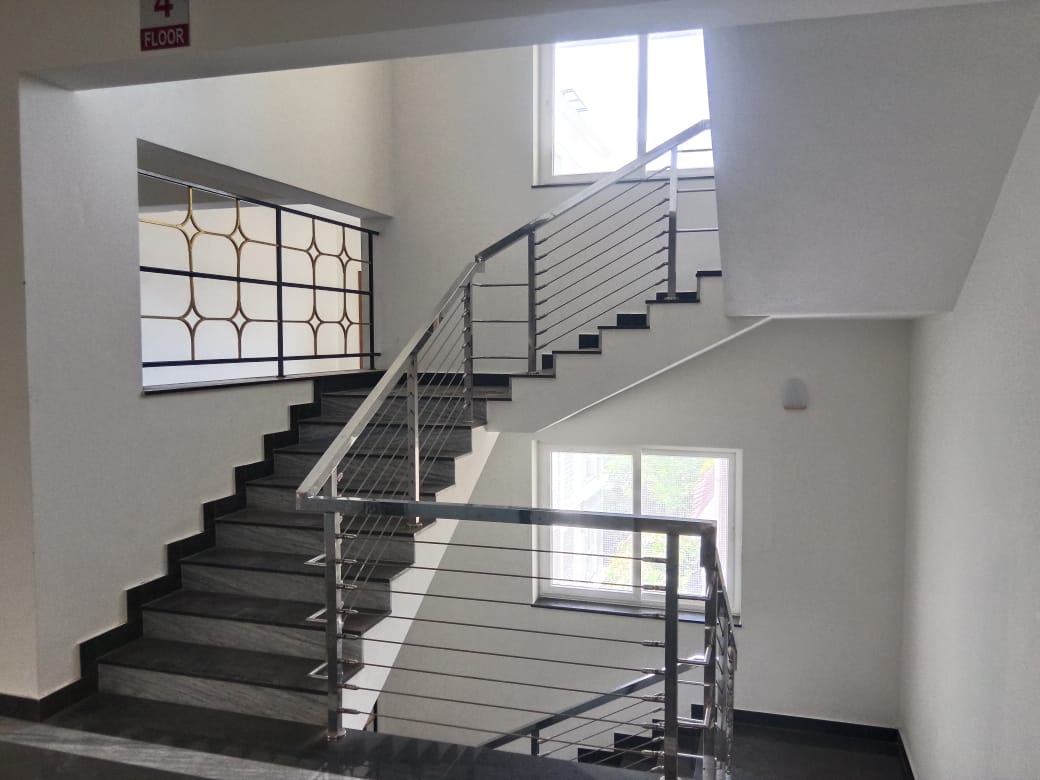

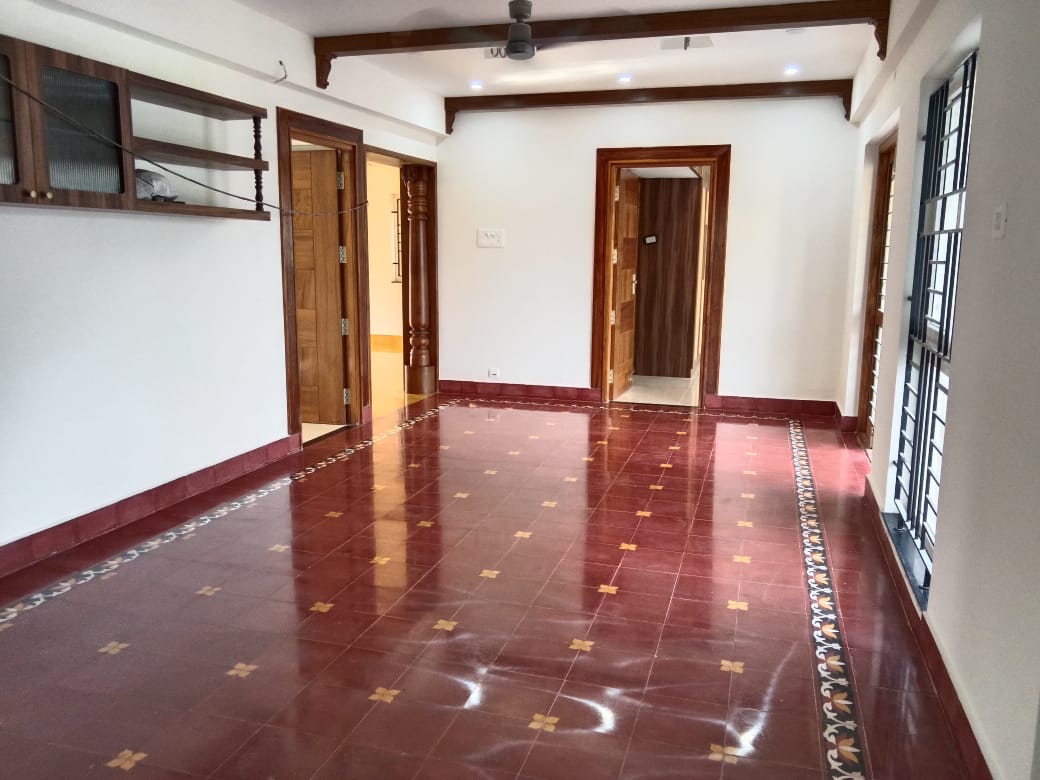

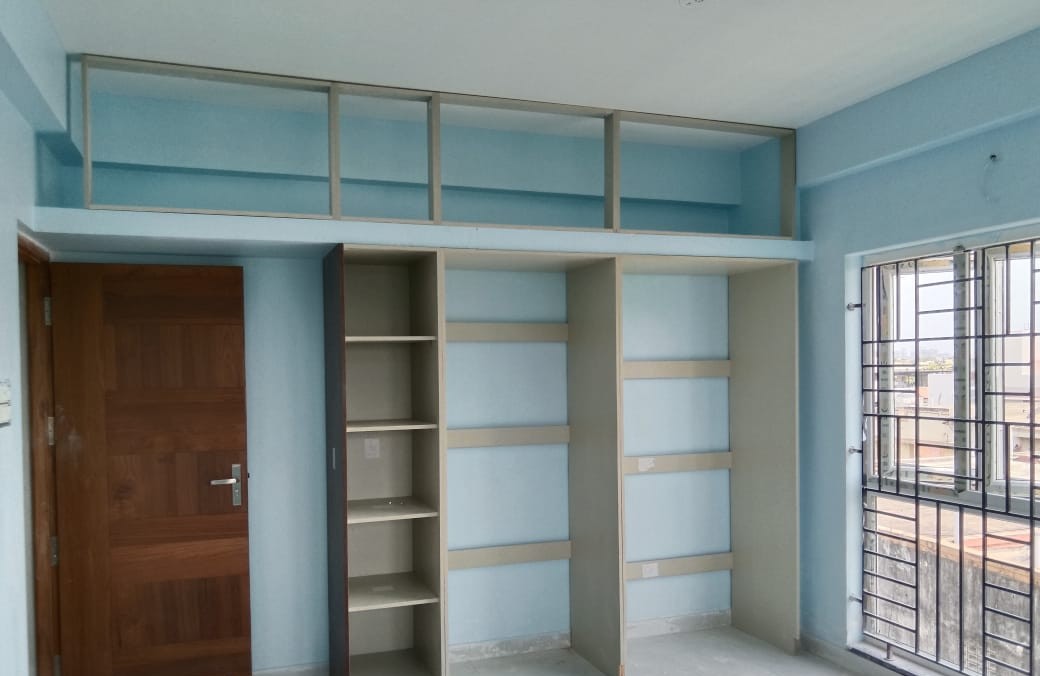

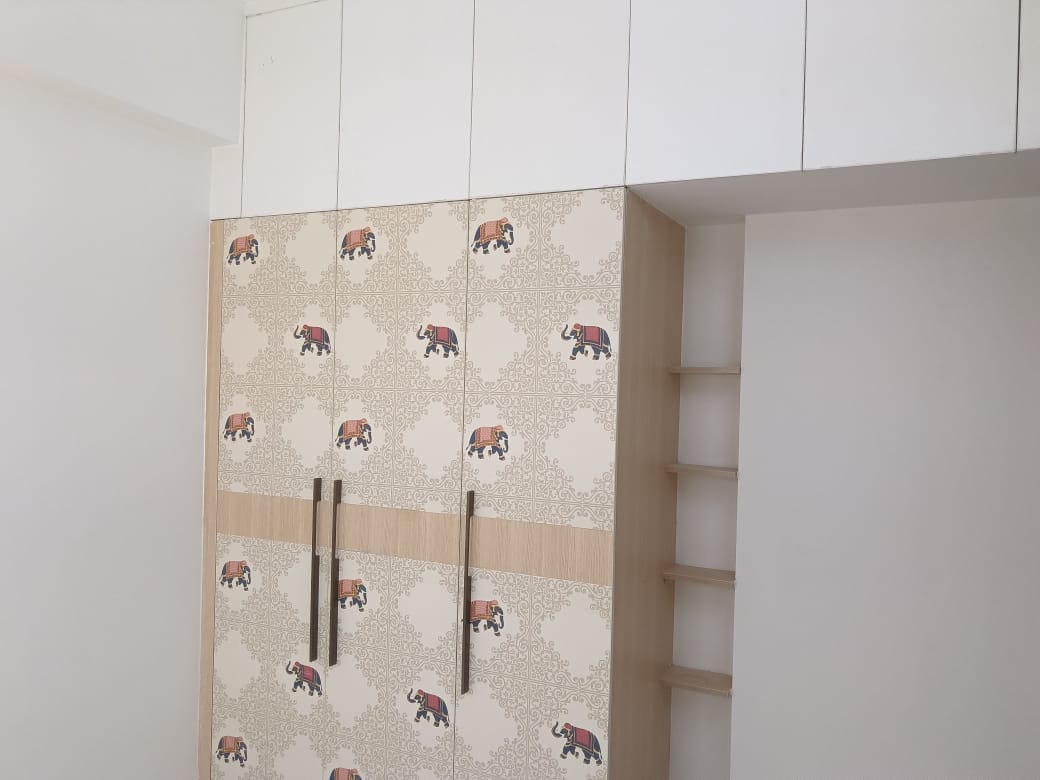

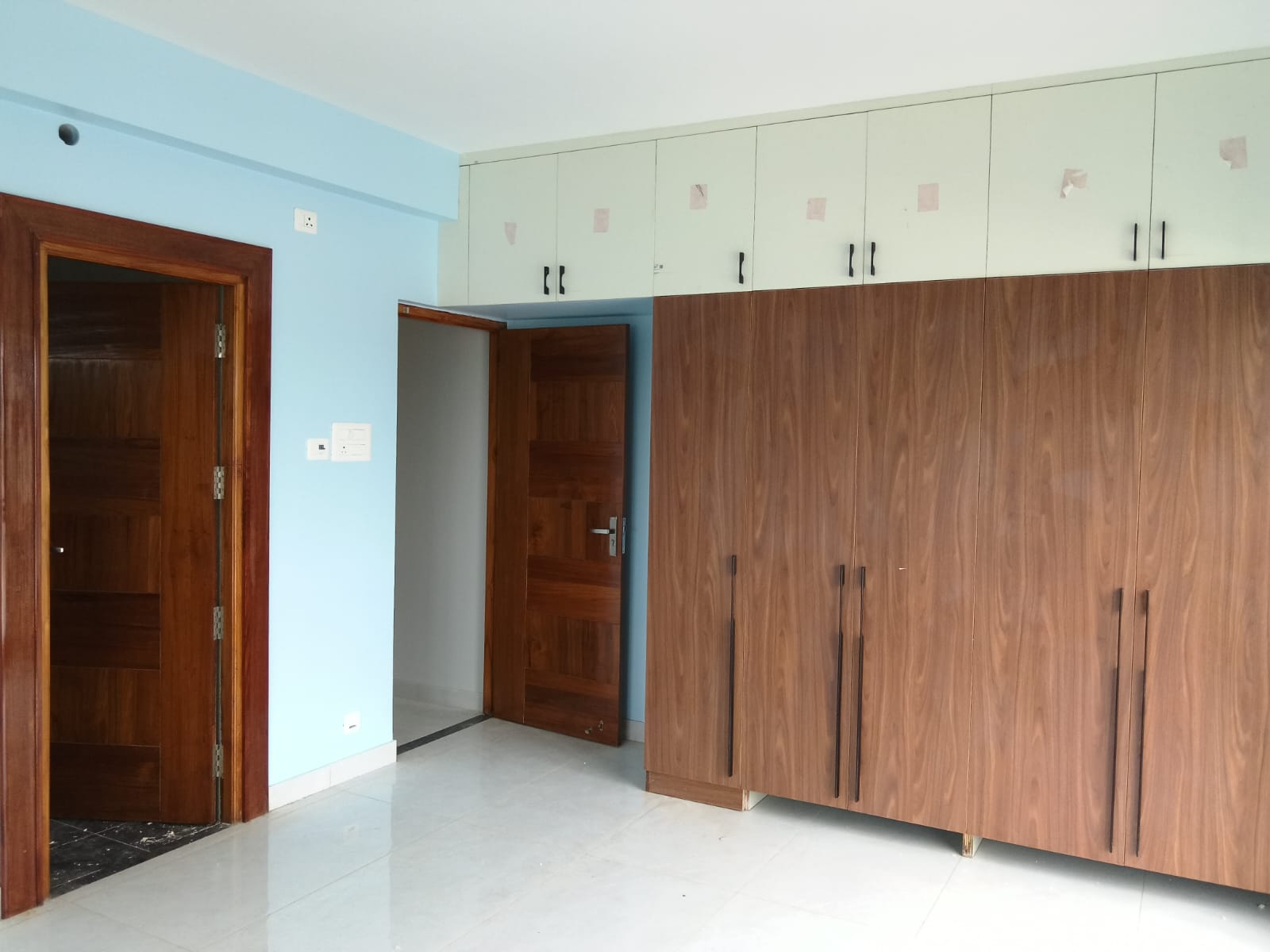

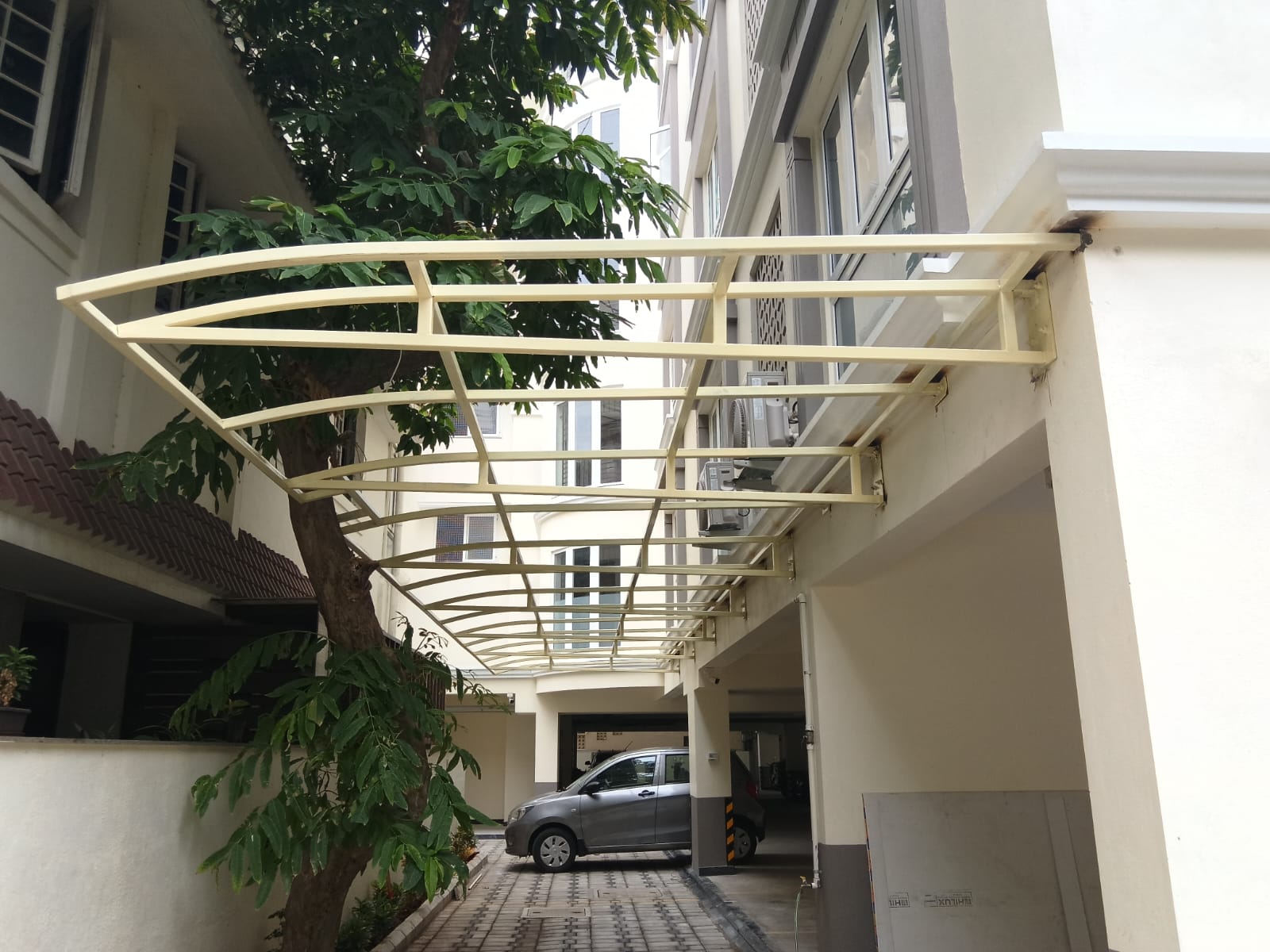

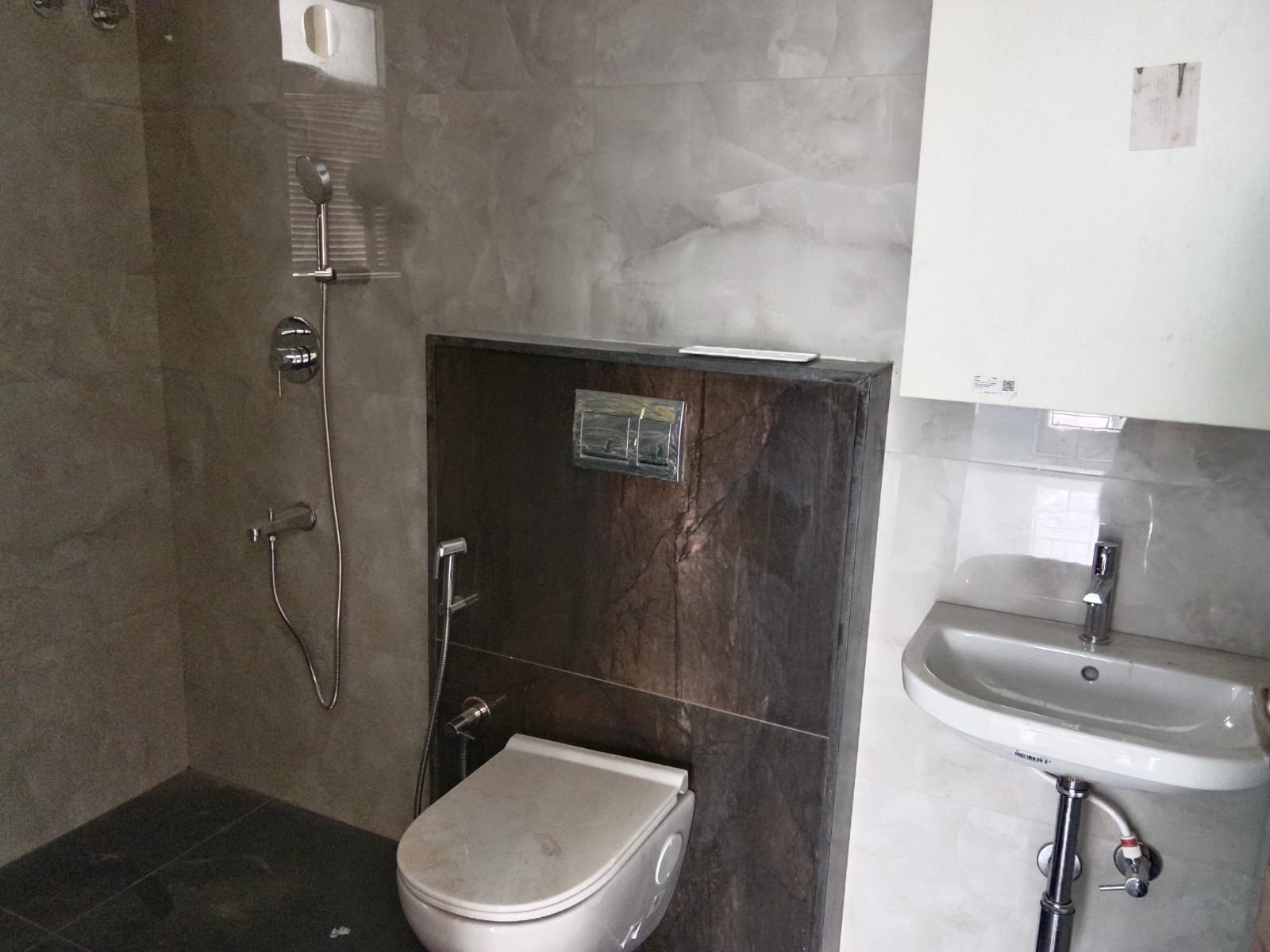

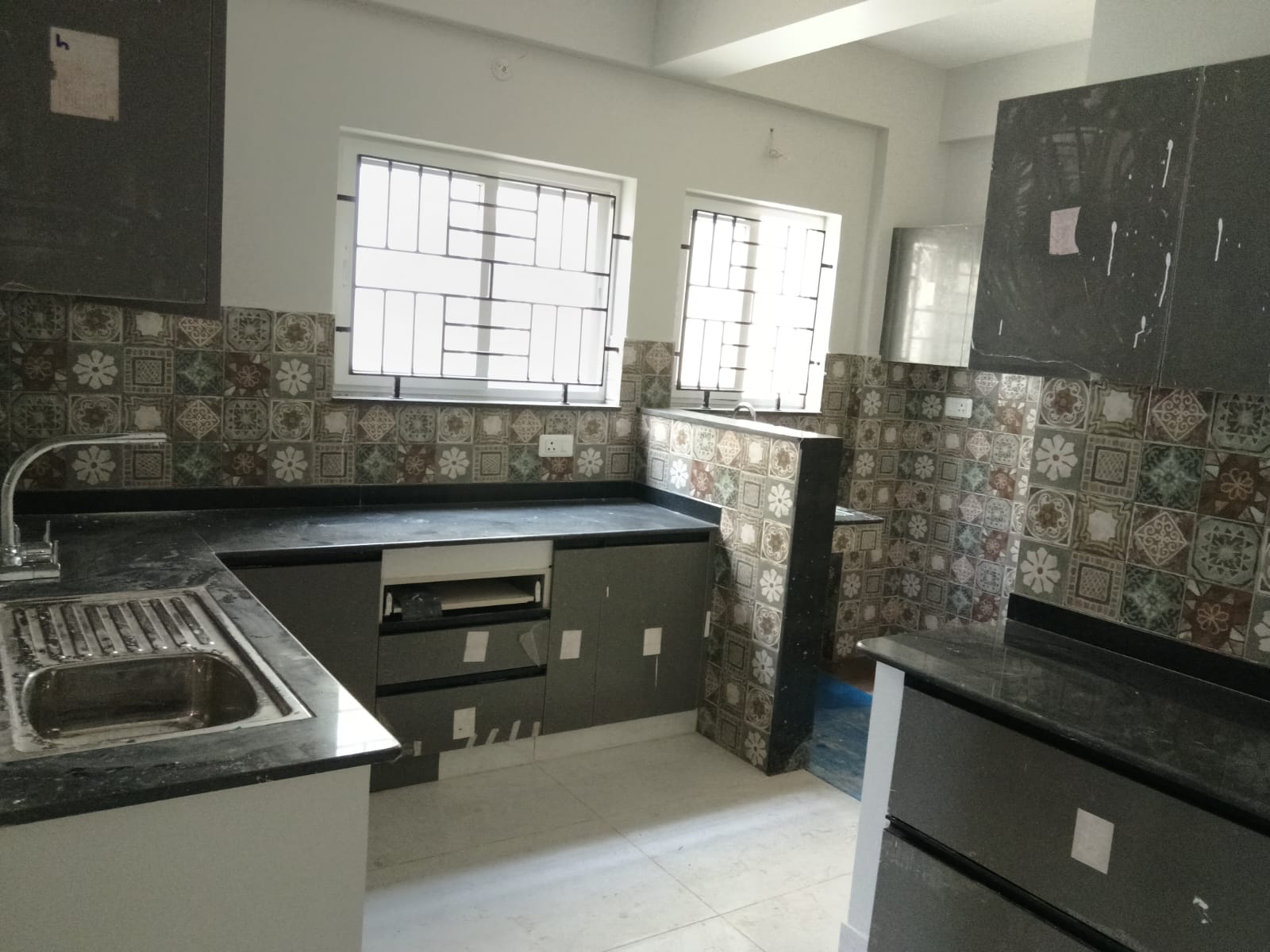

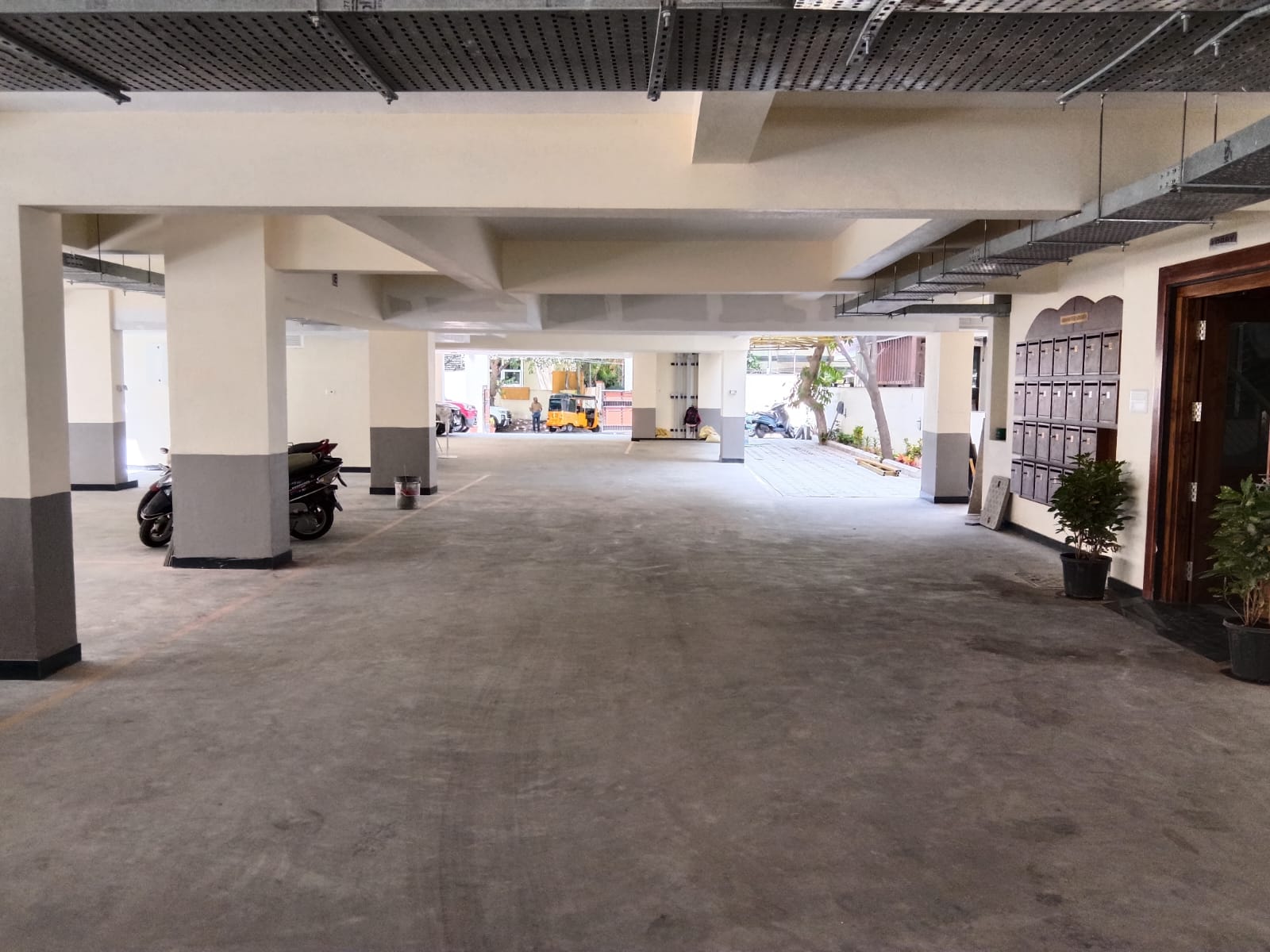

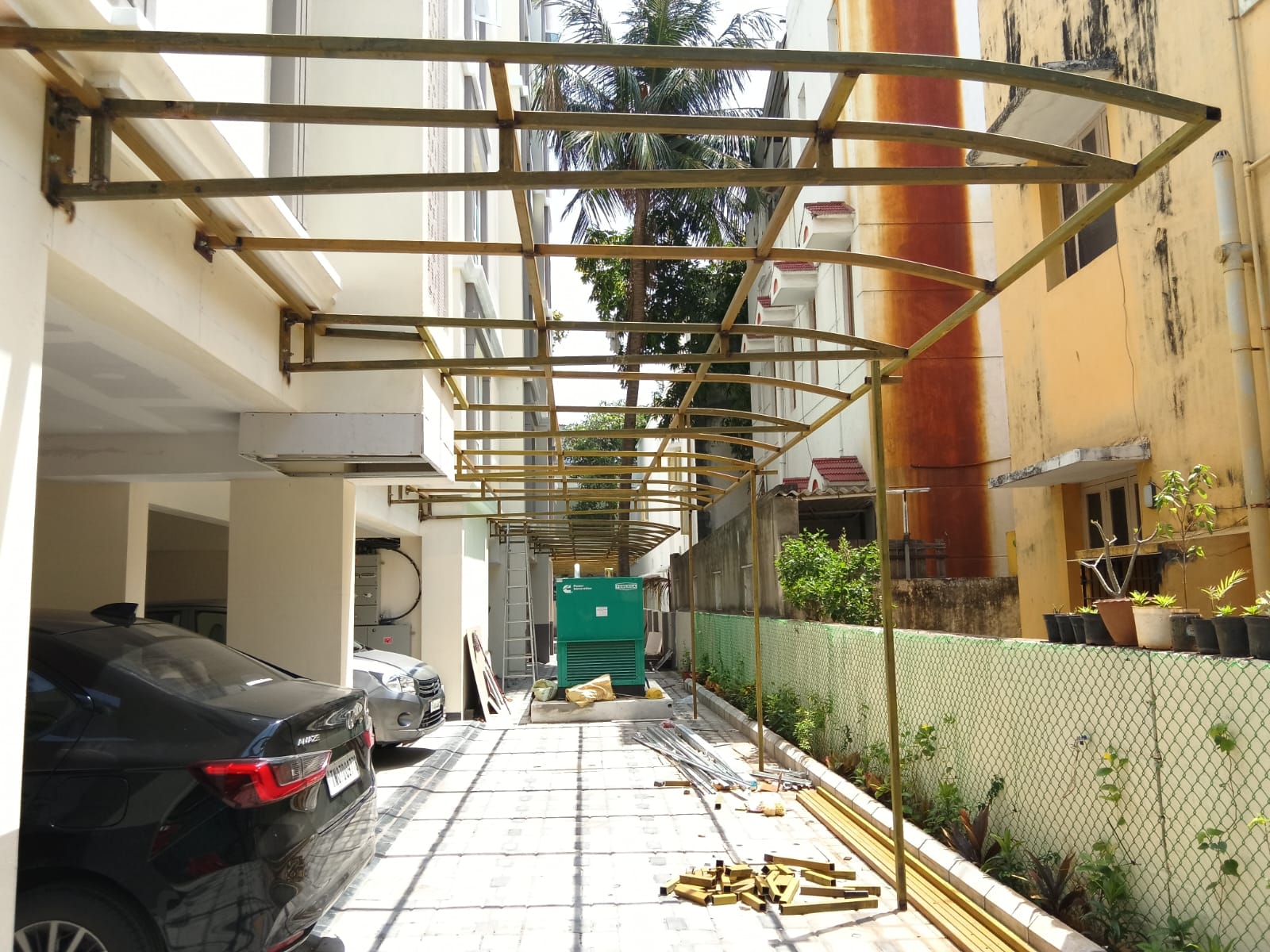

Project Update Images

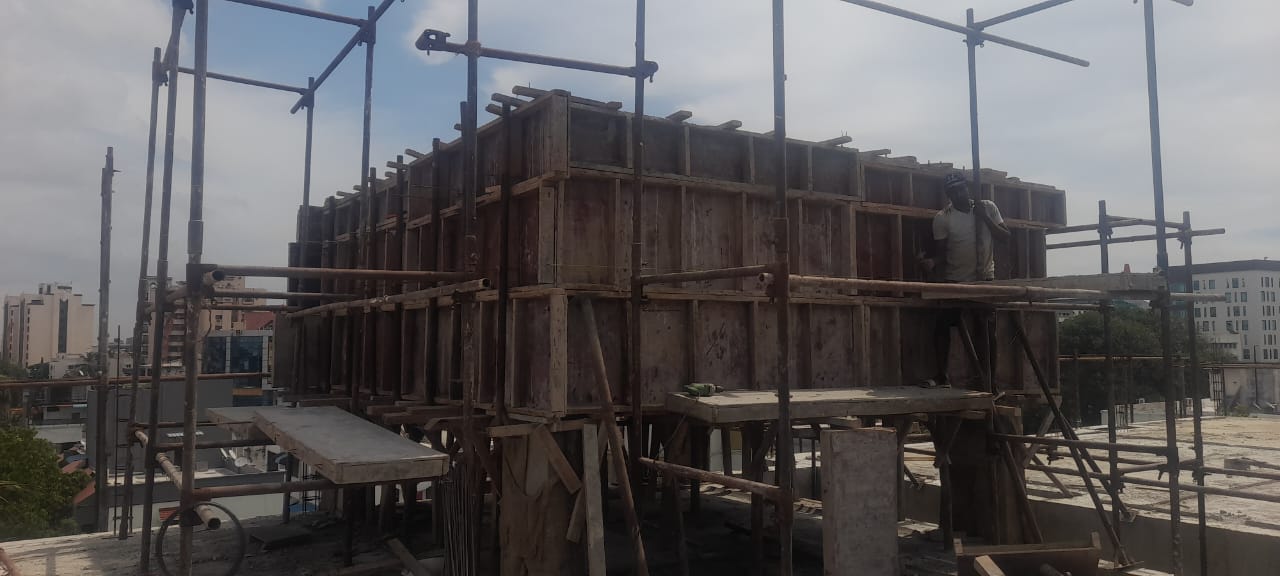

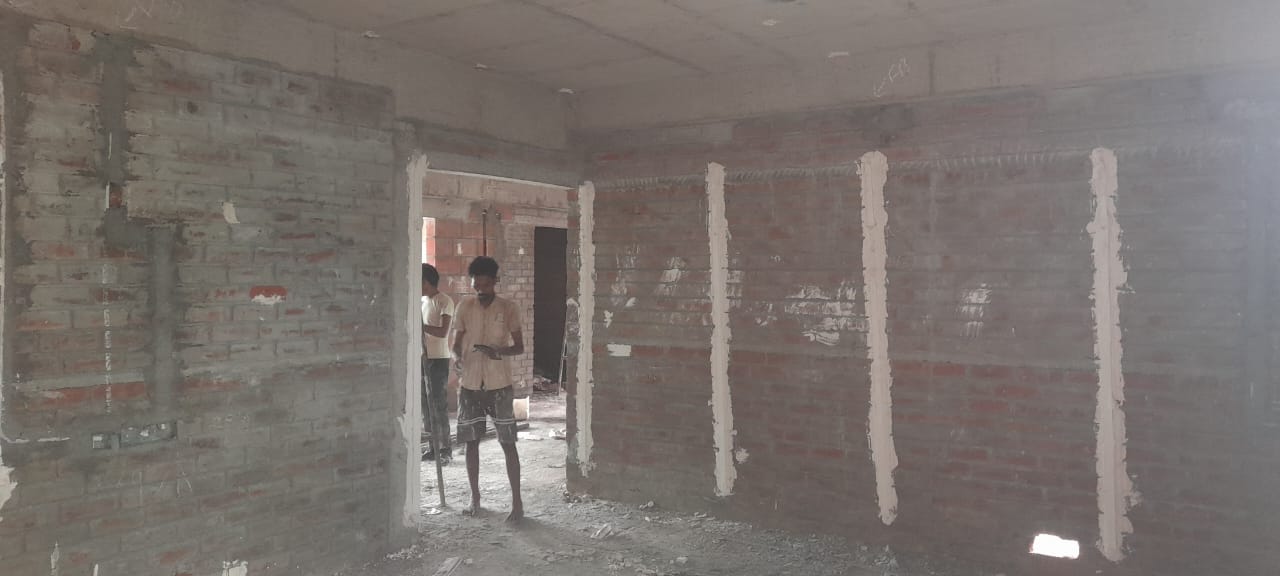

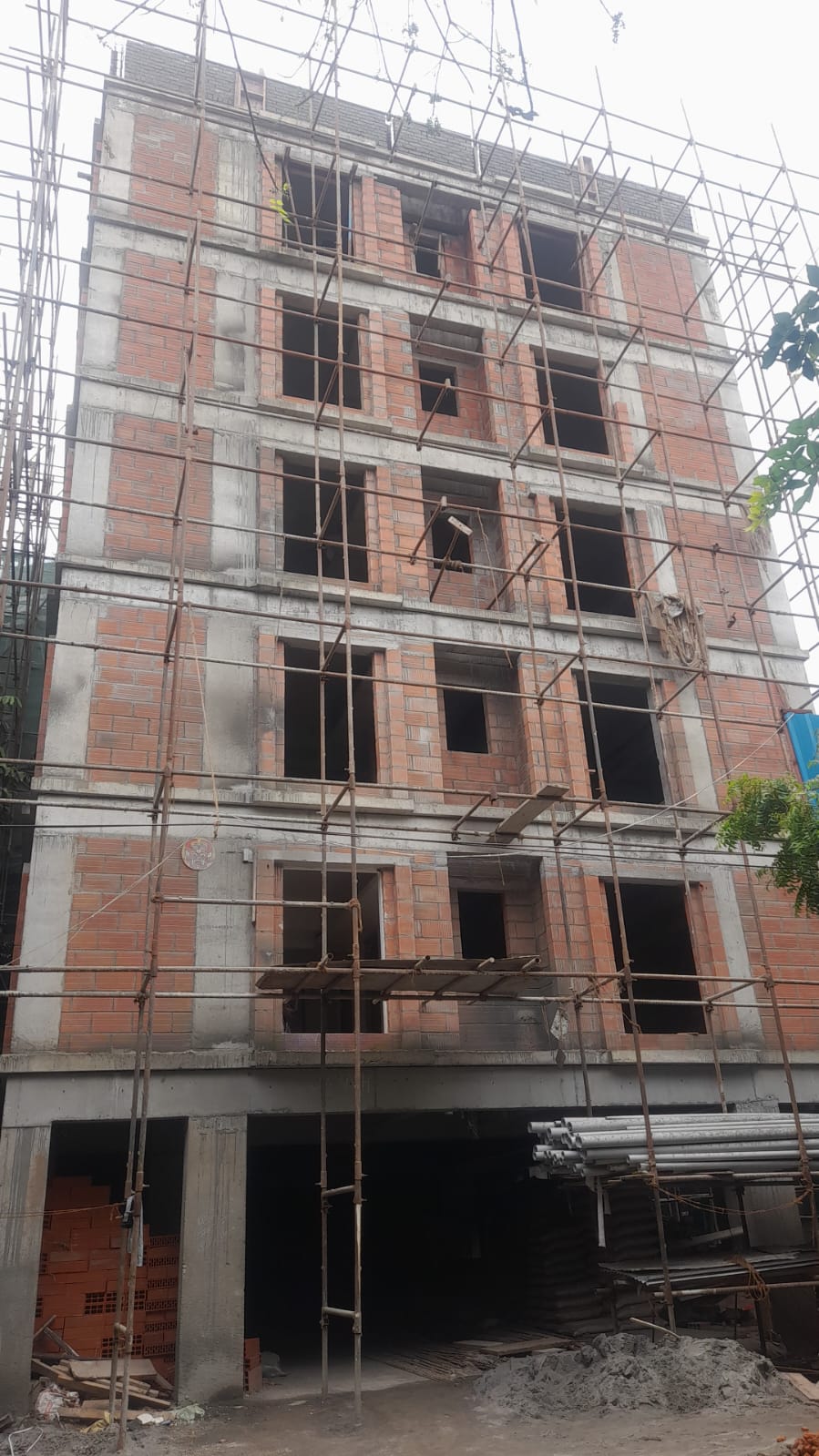

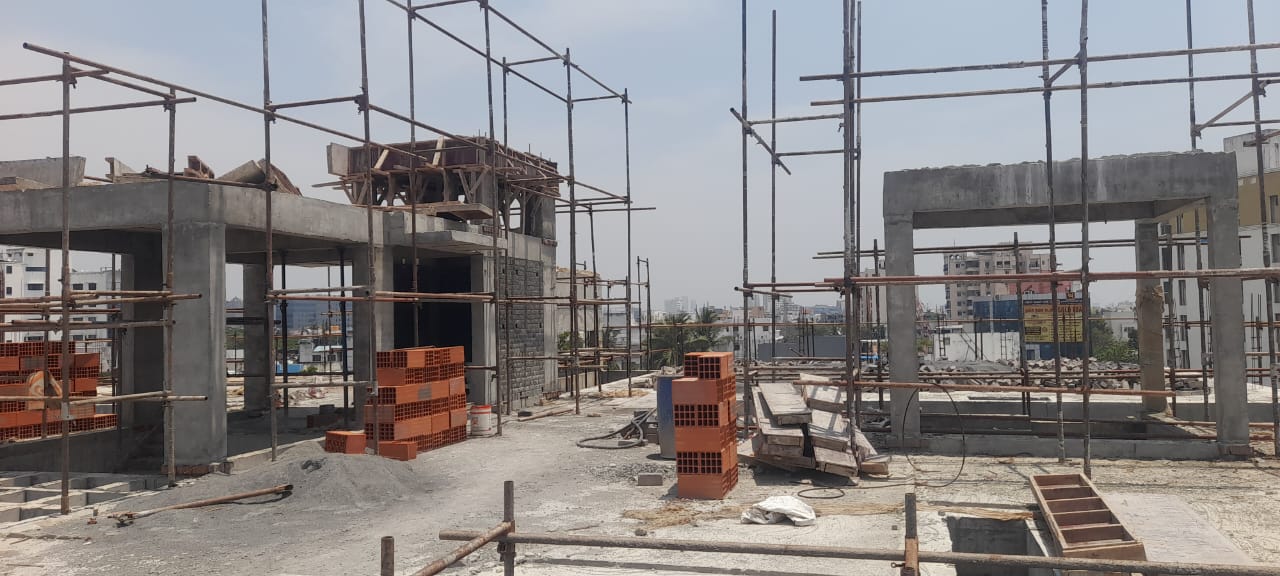

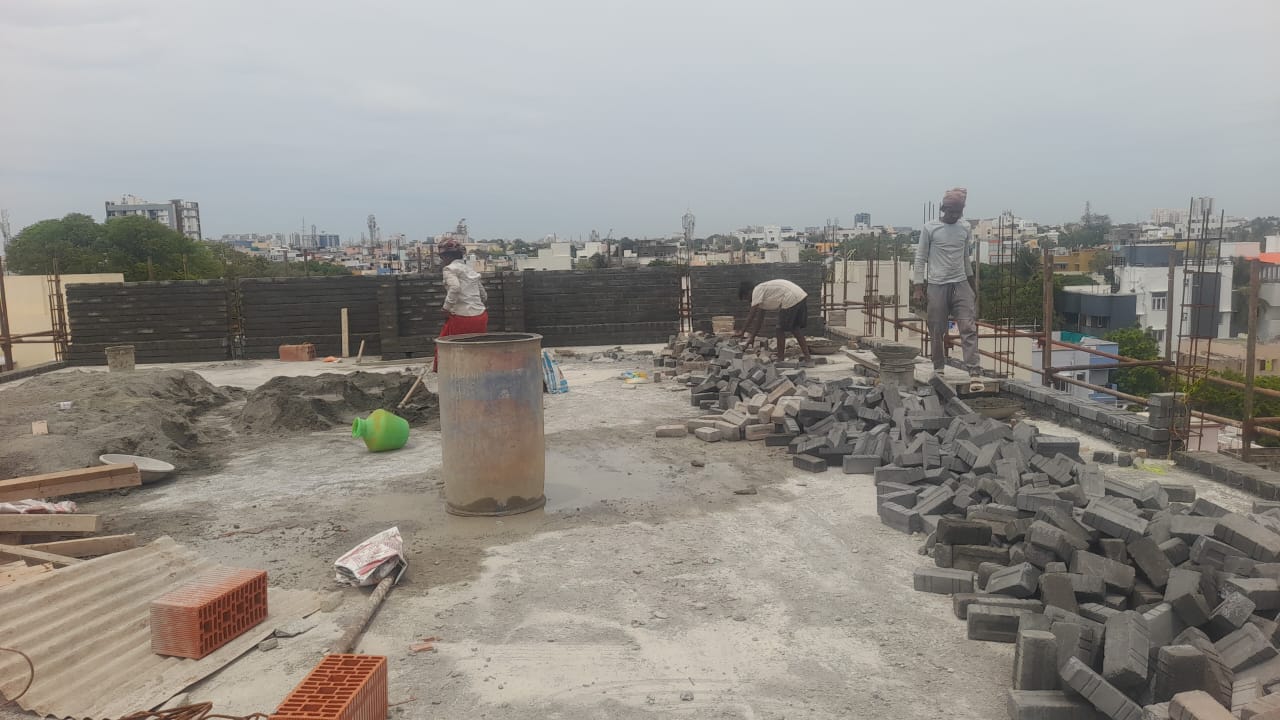

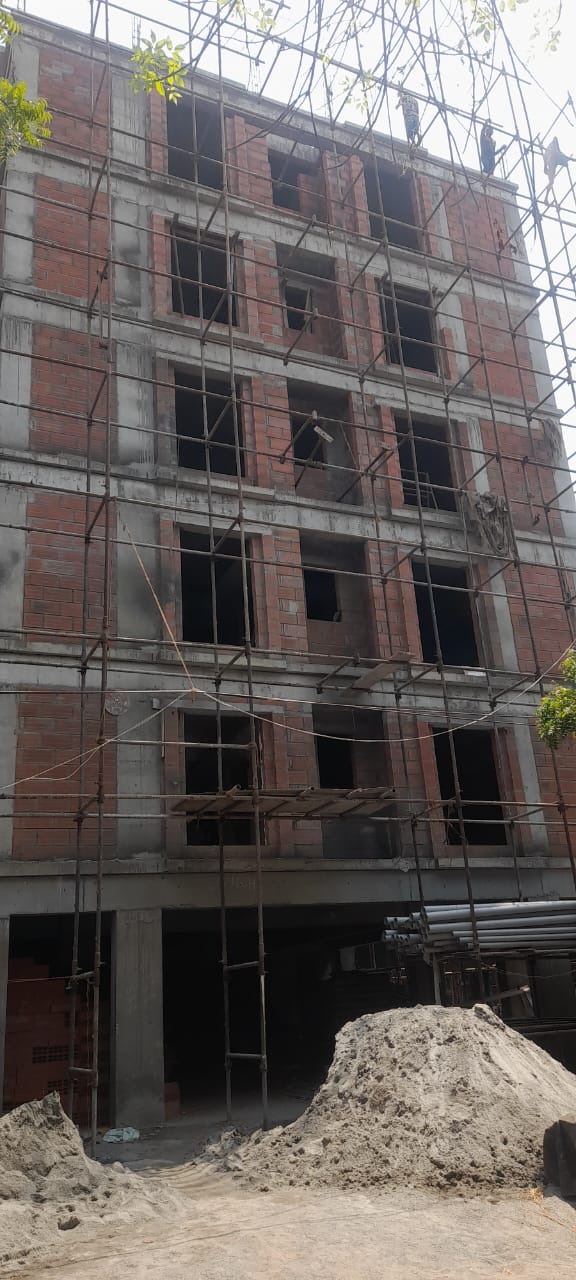

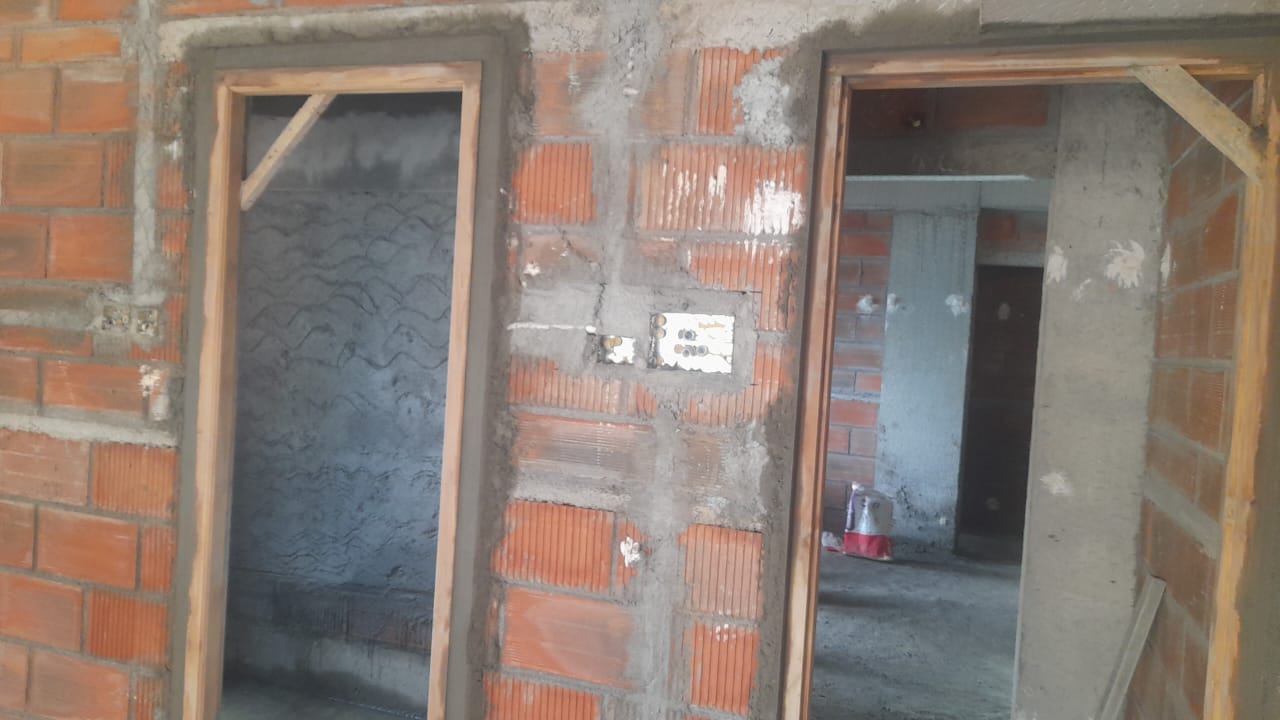

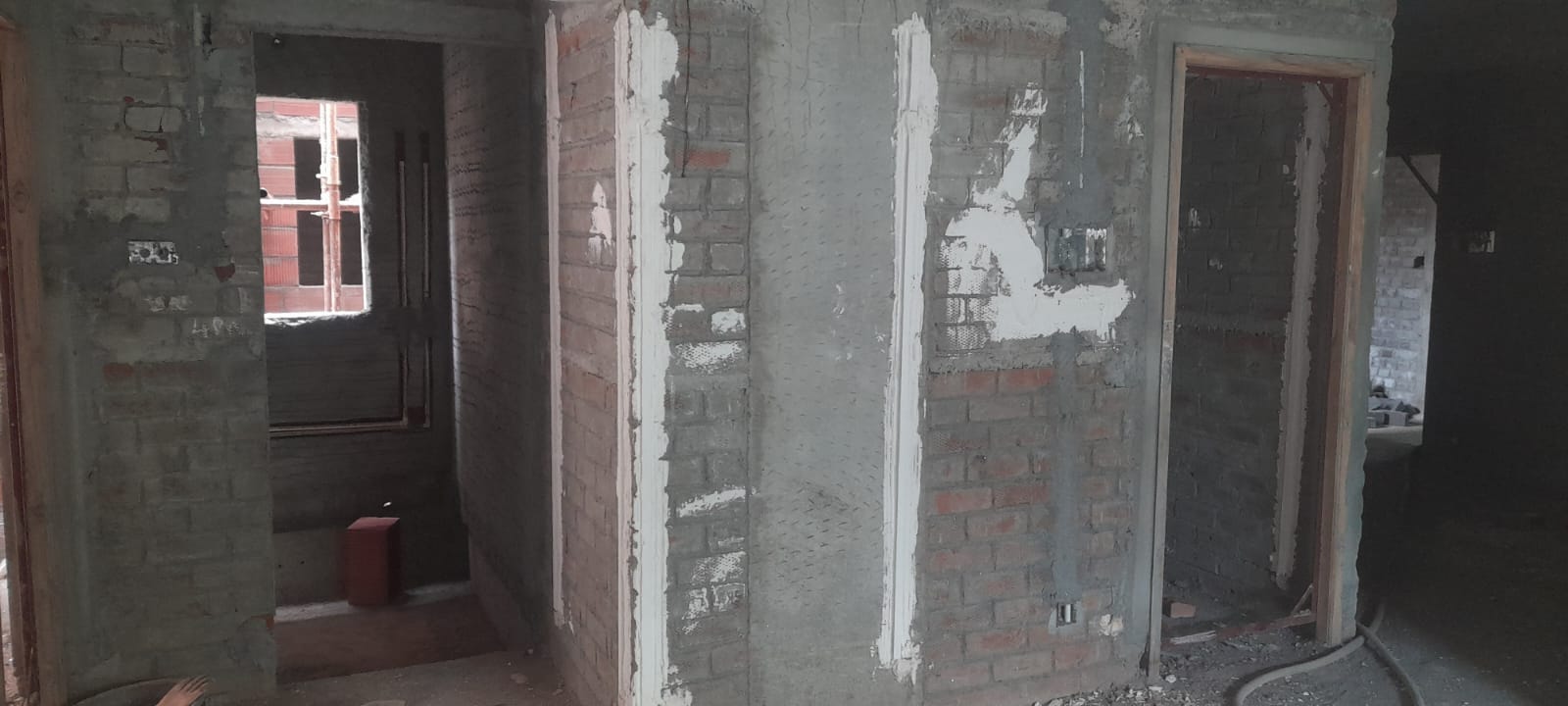

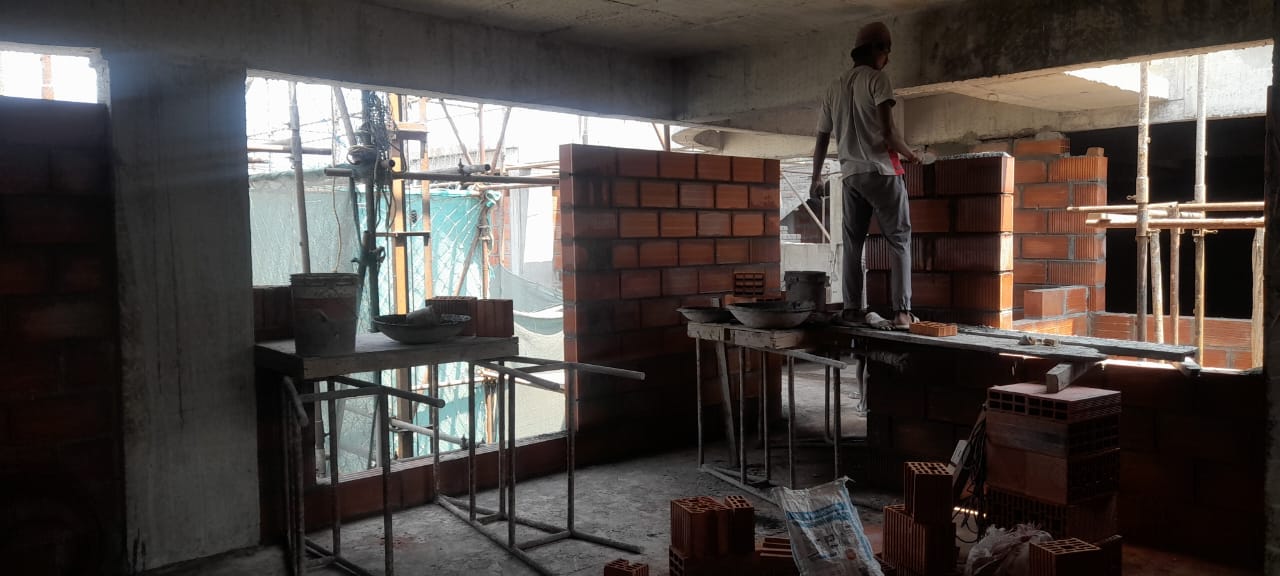

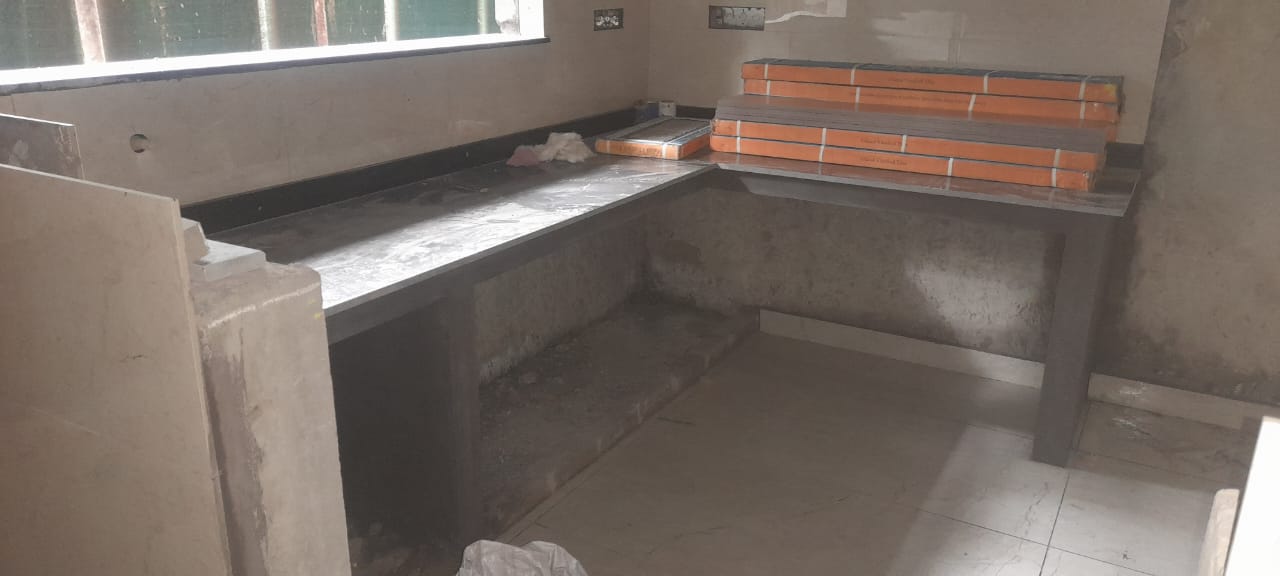

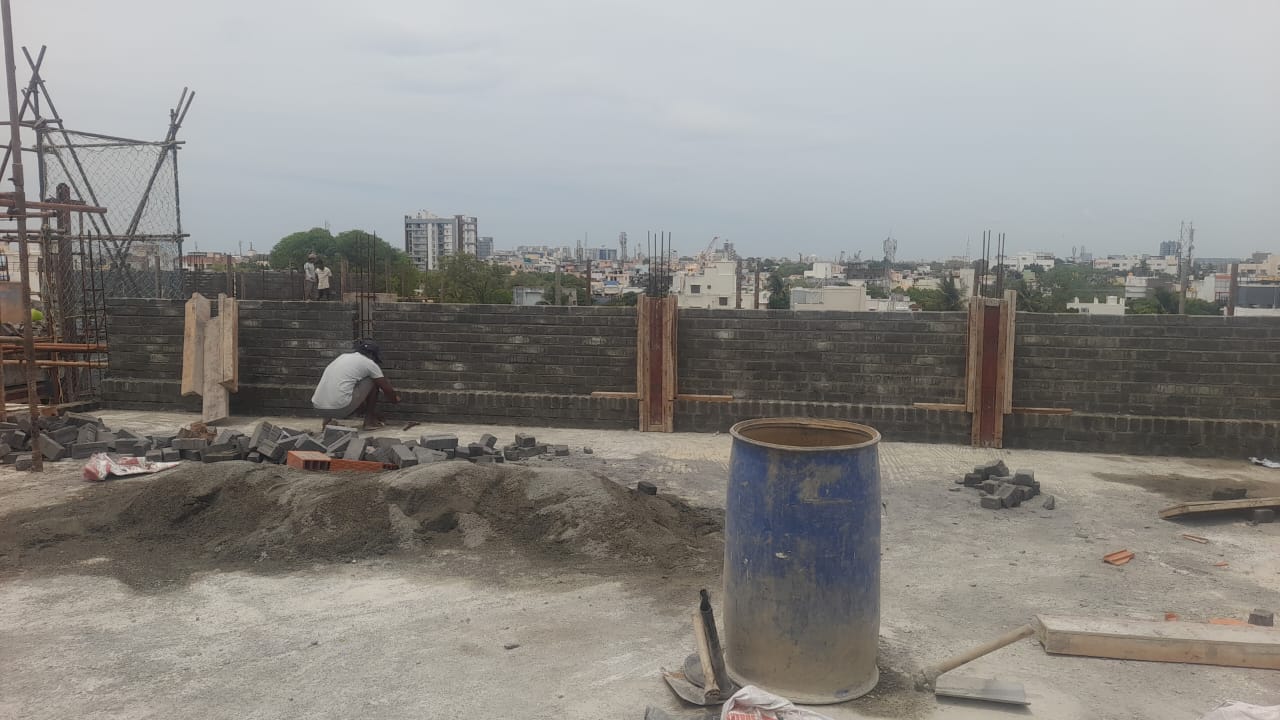

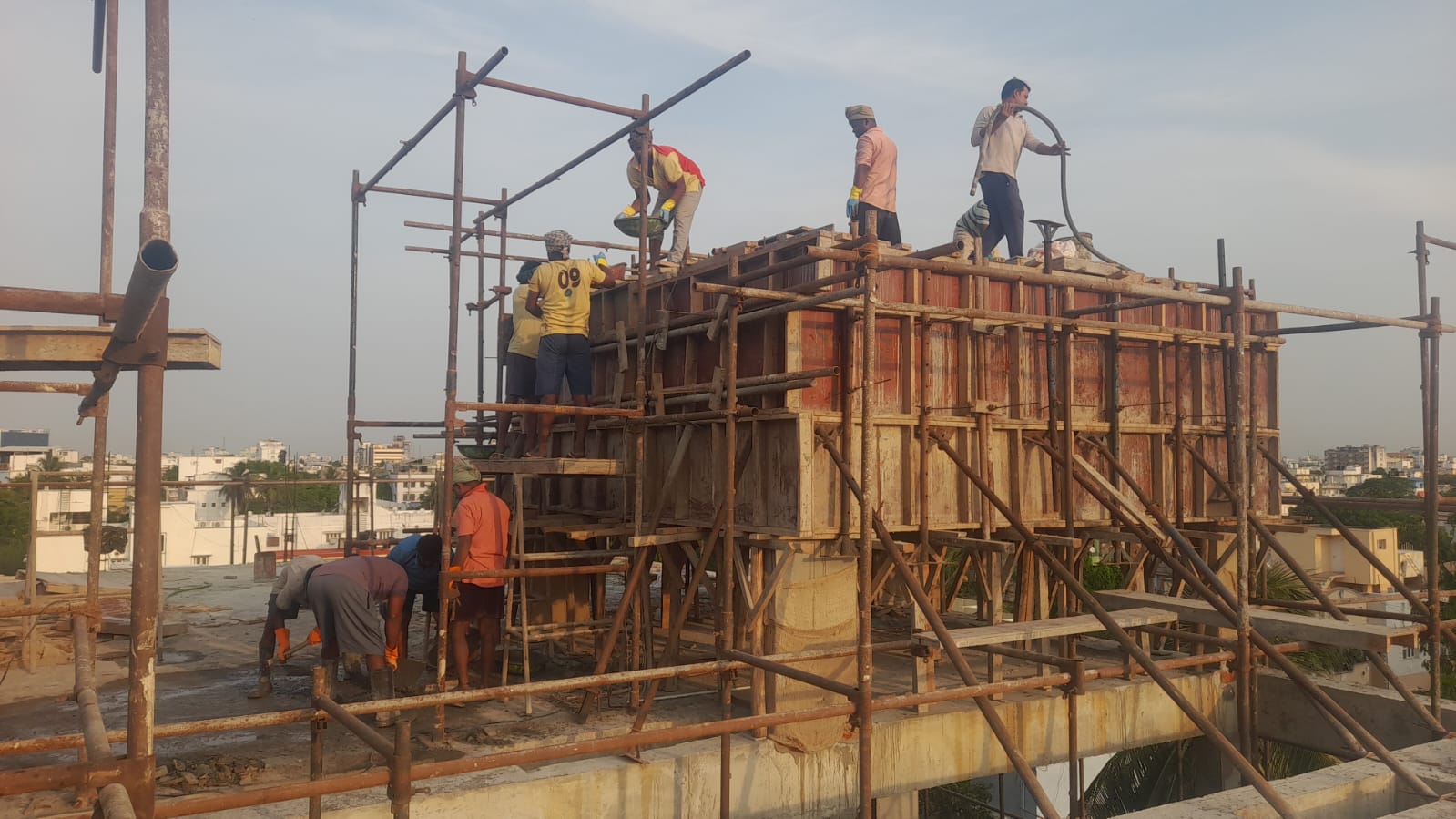

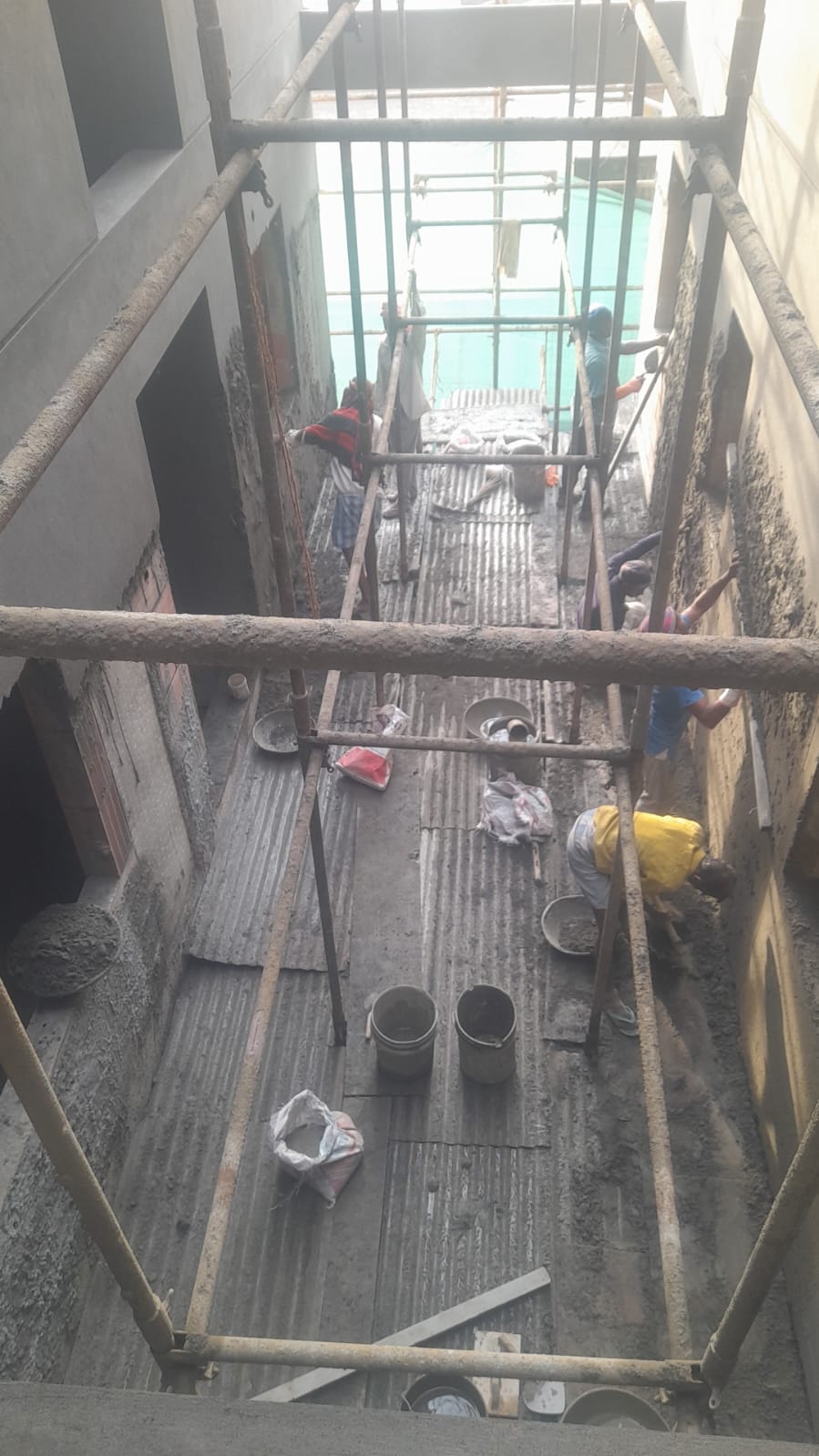

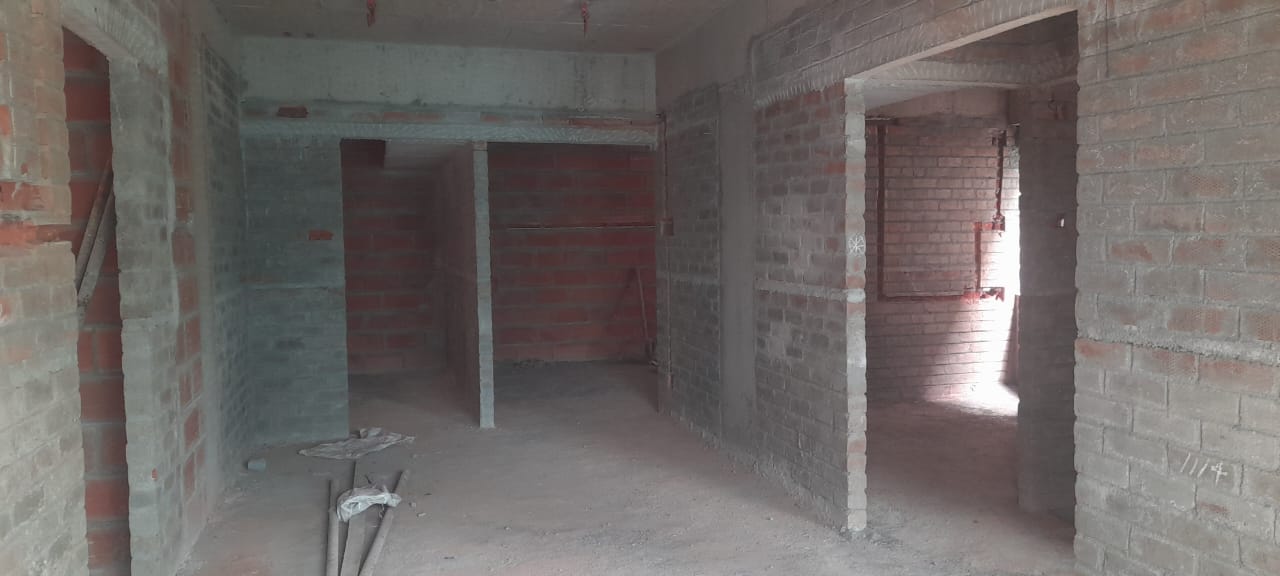

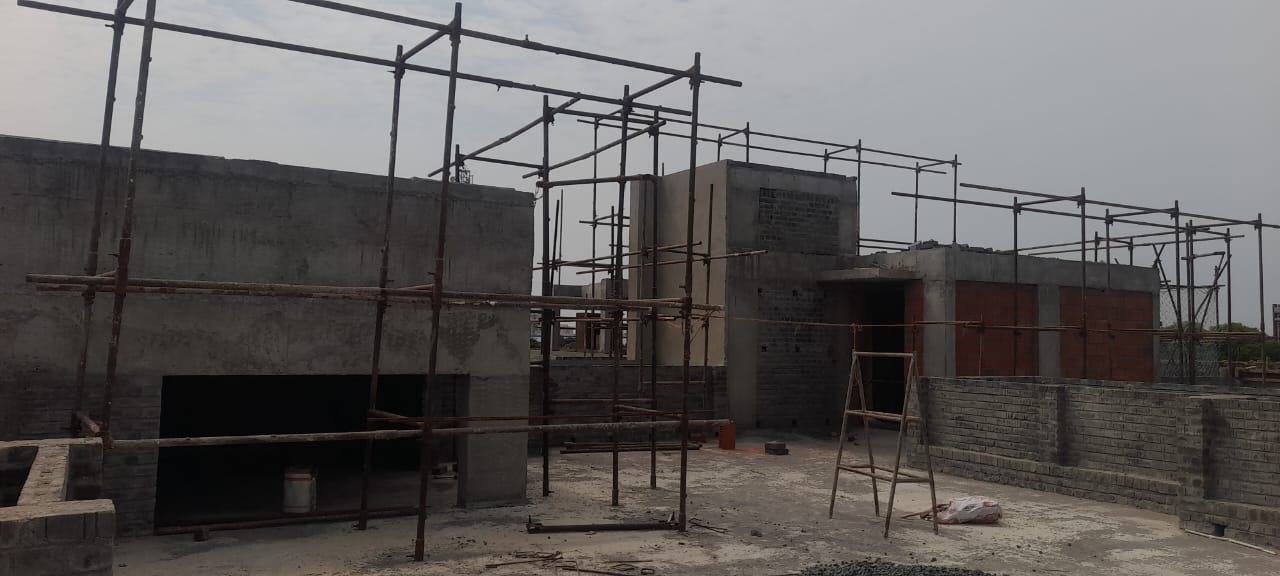

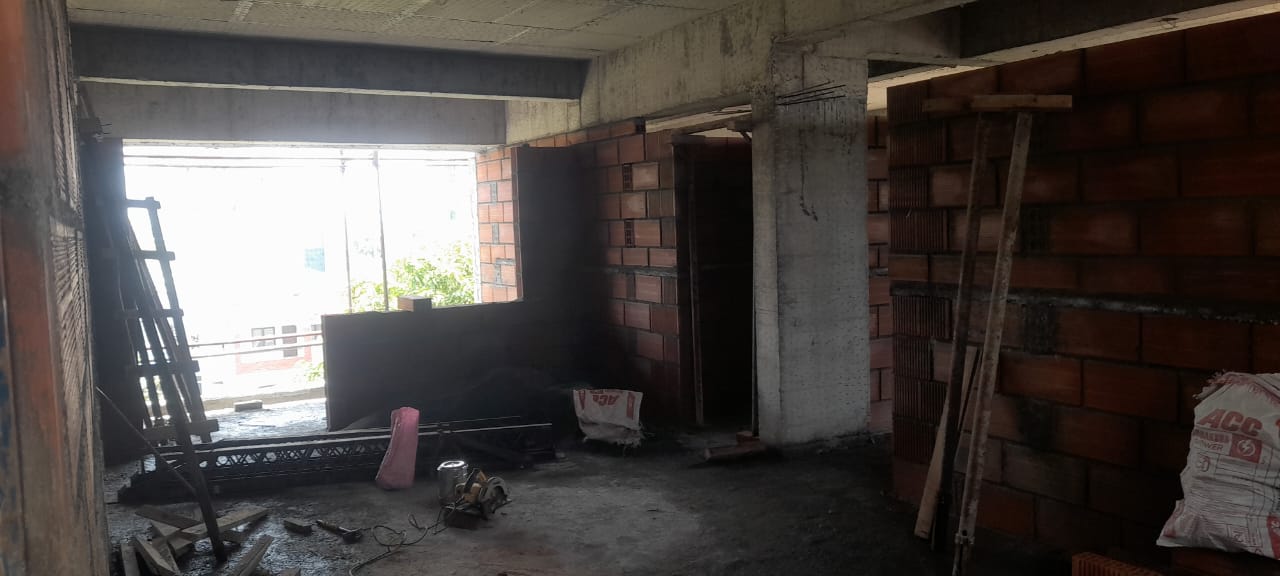

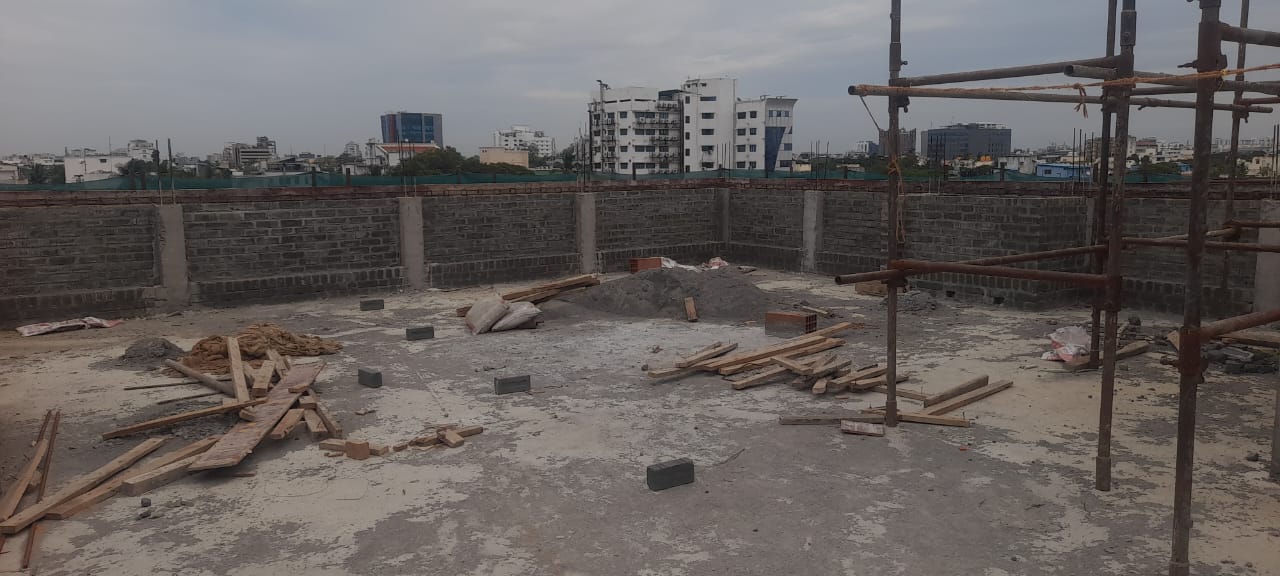

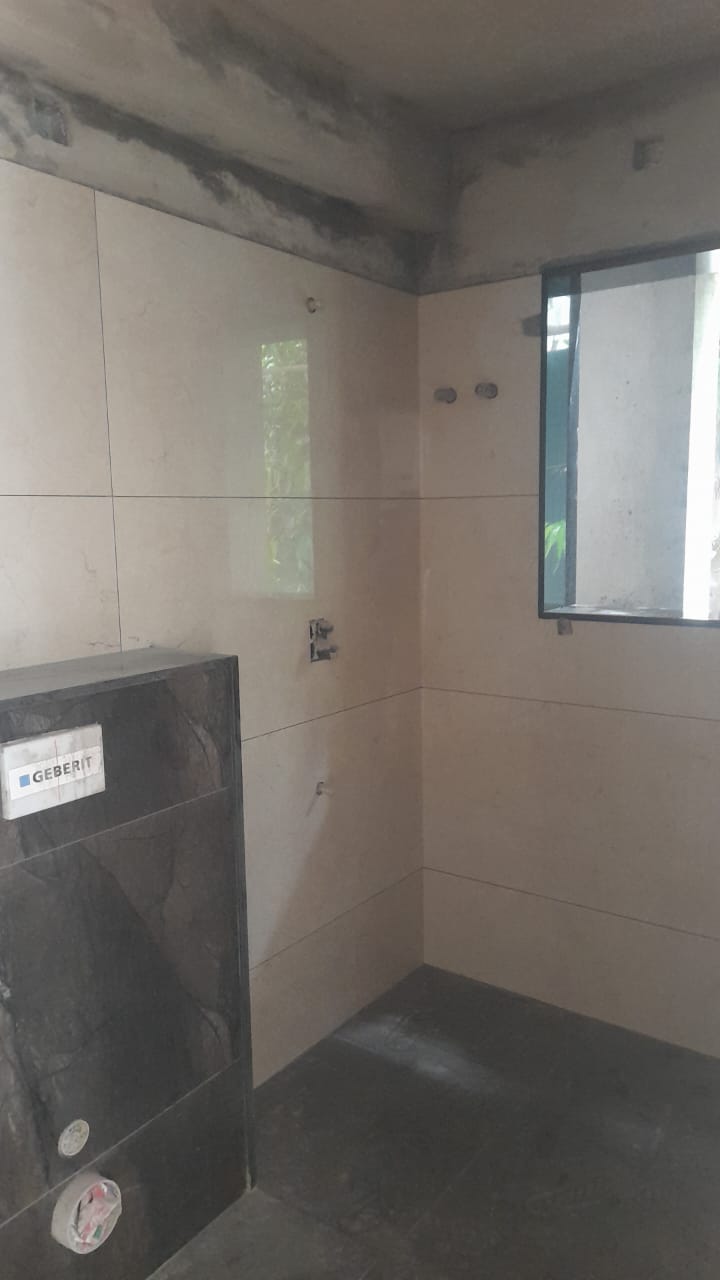

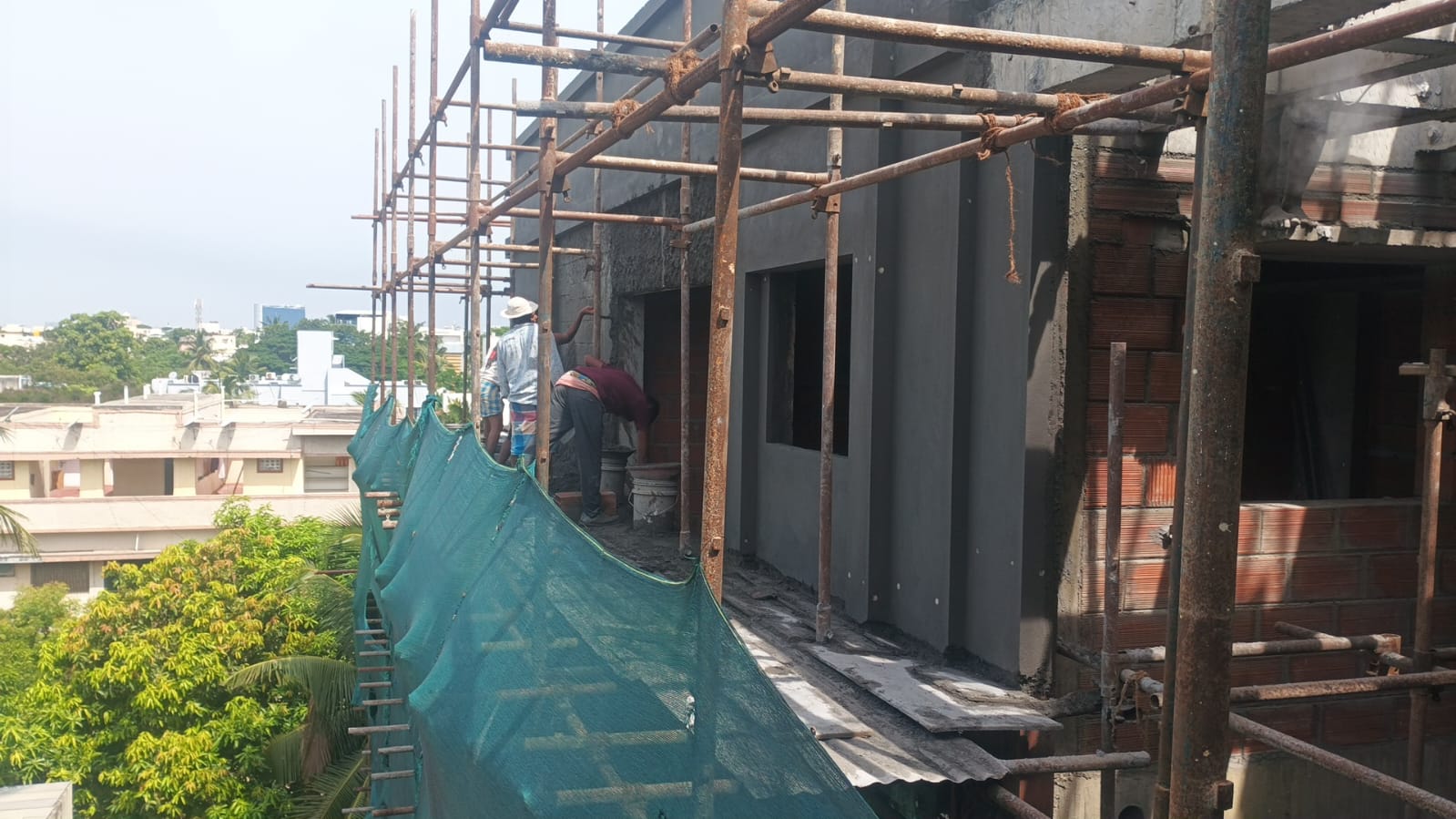

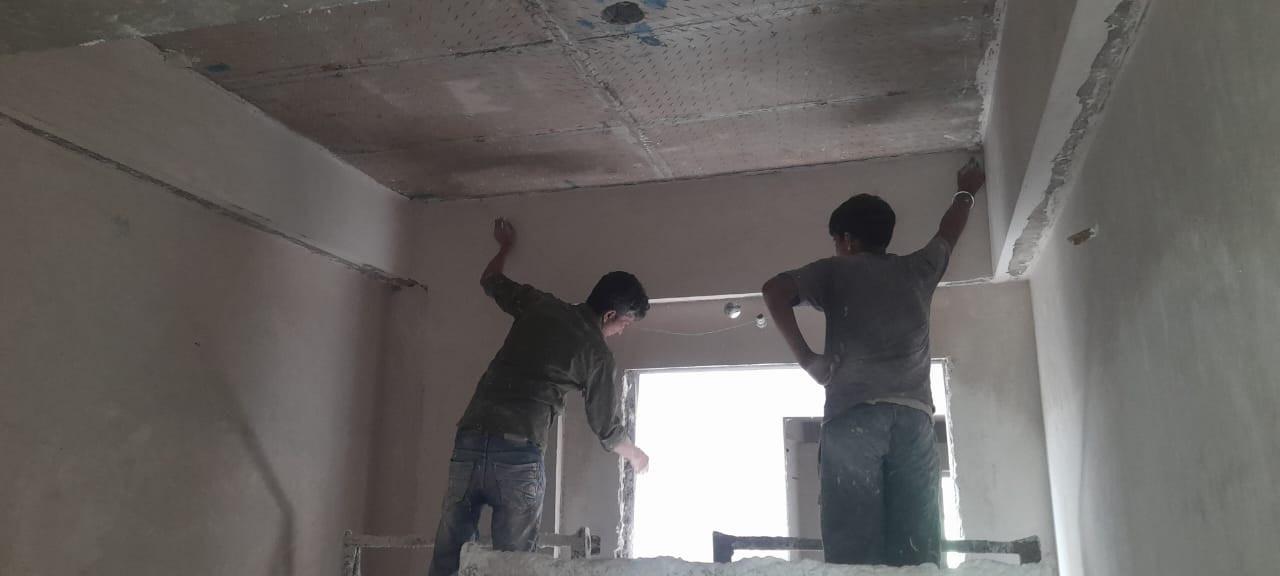

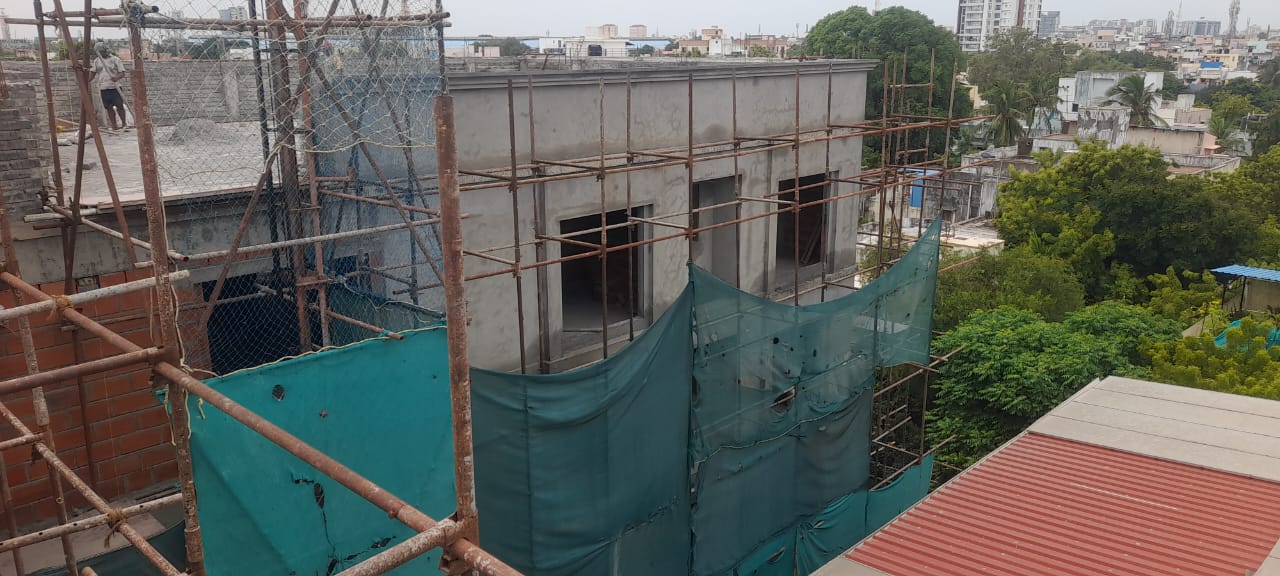

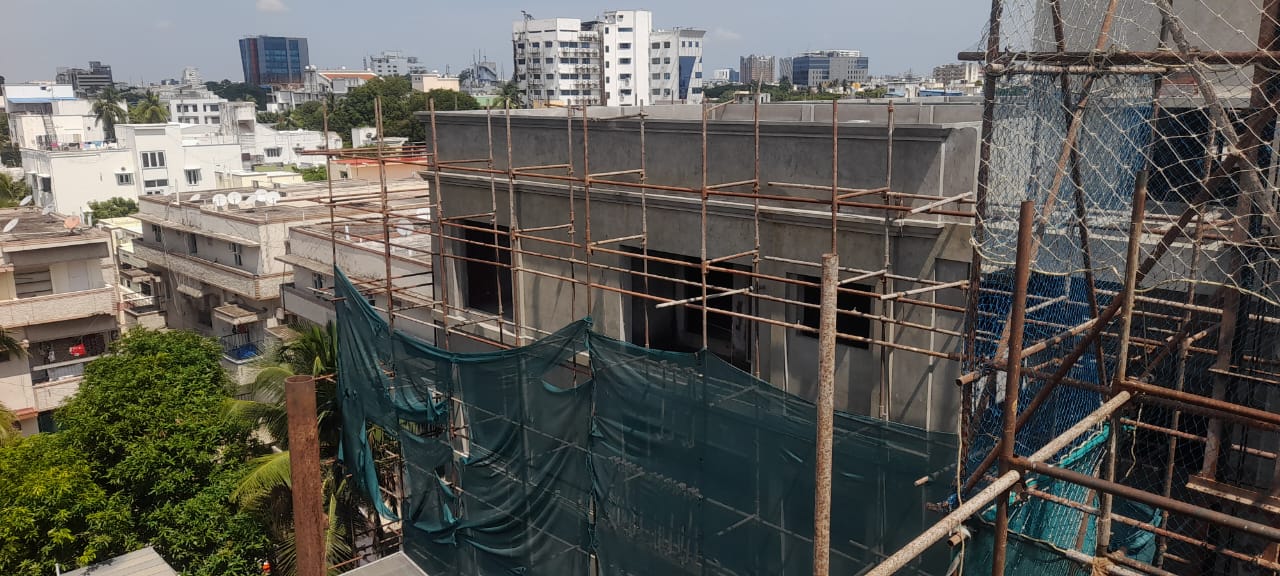

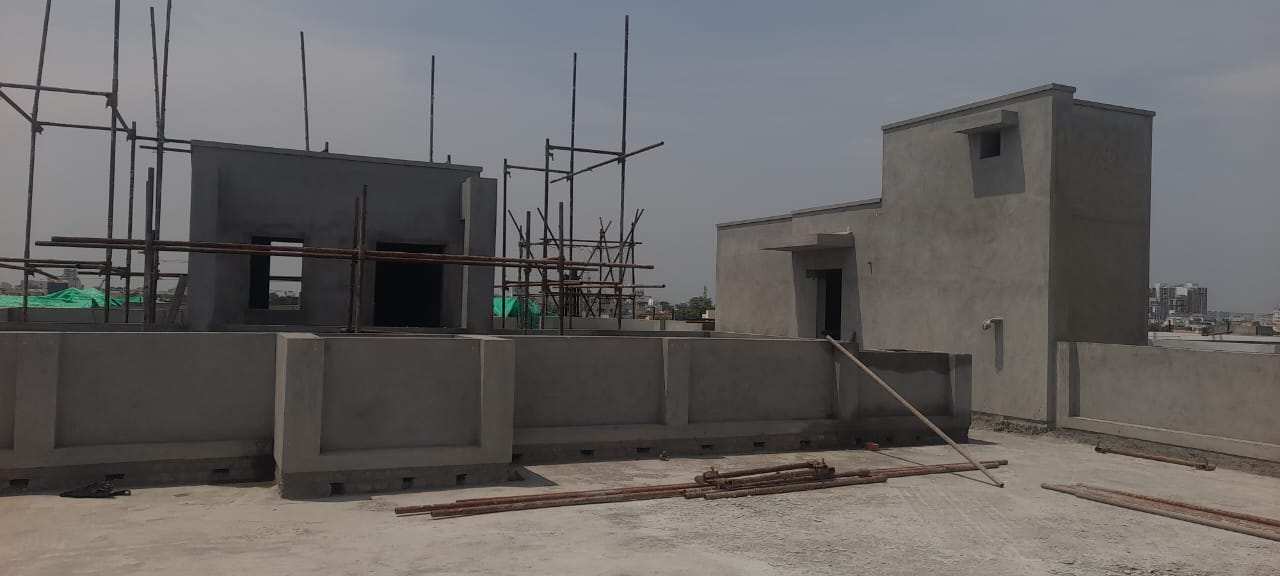

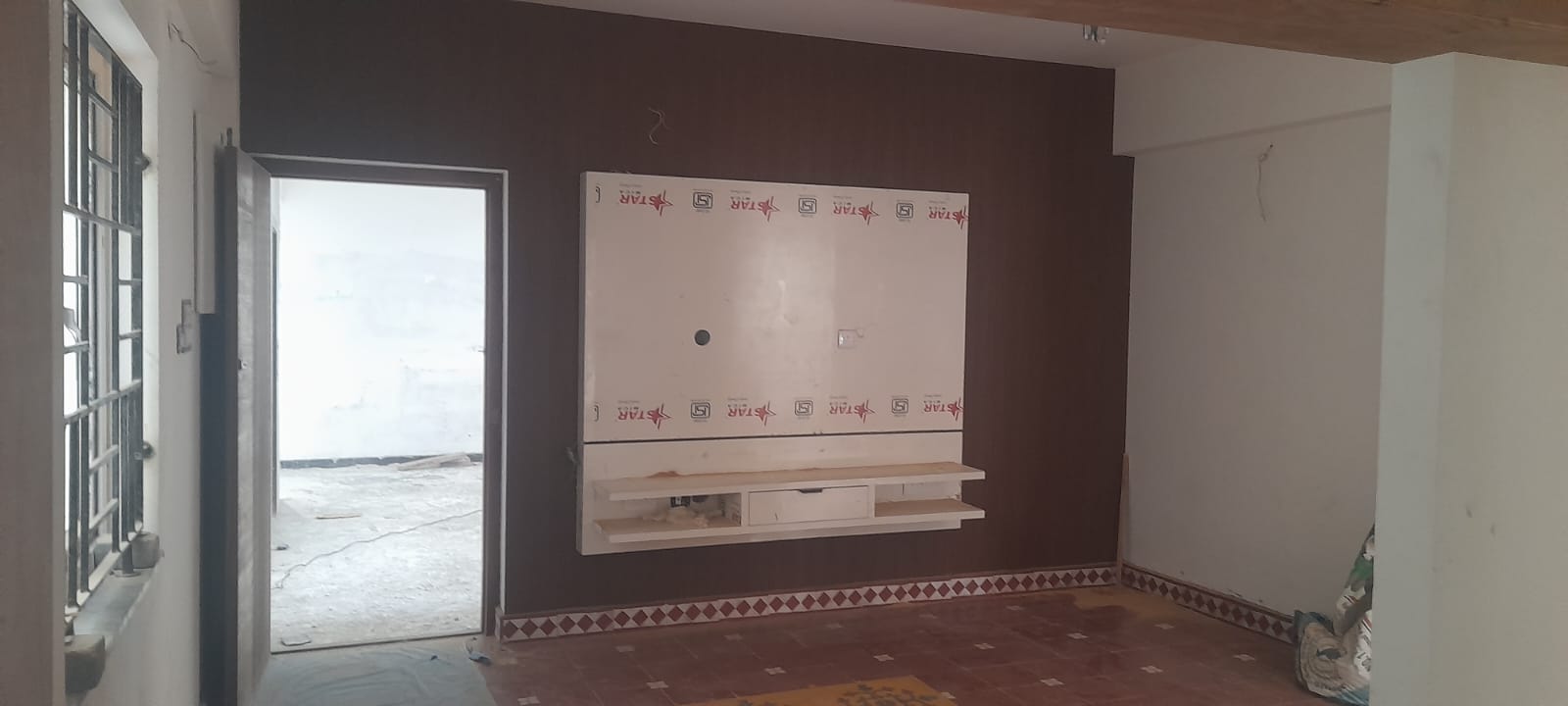

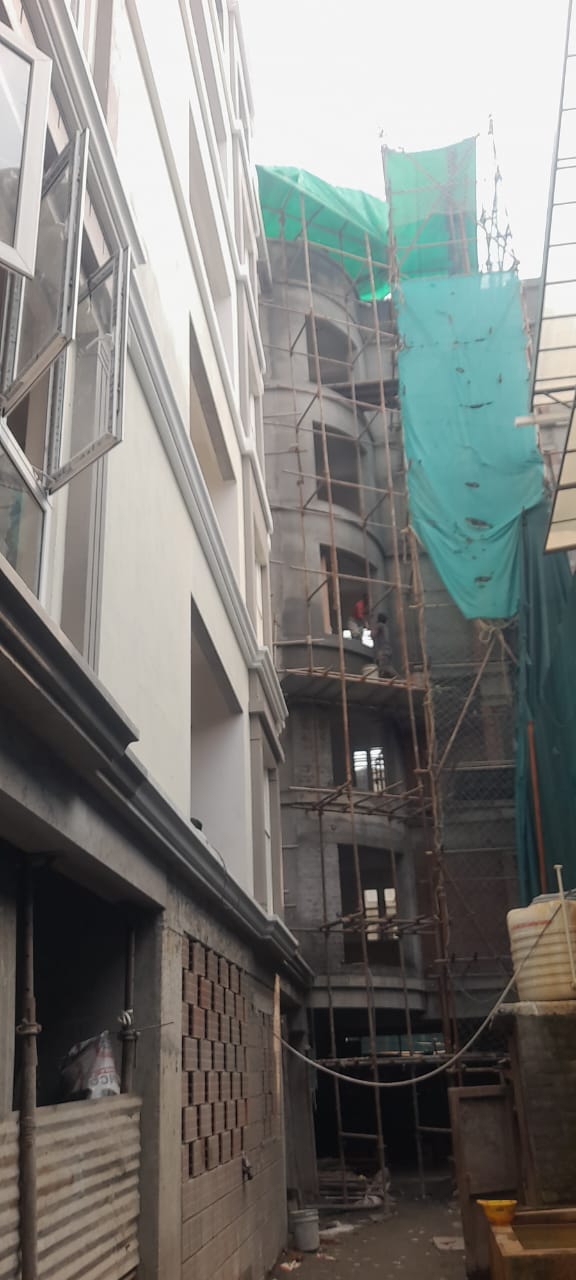

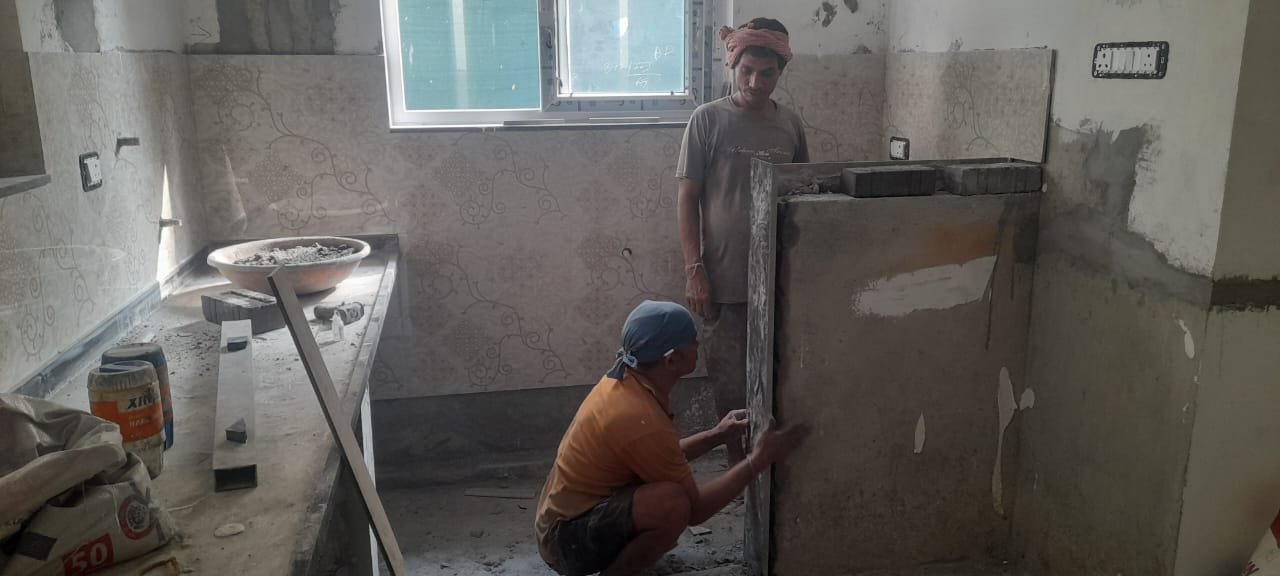

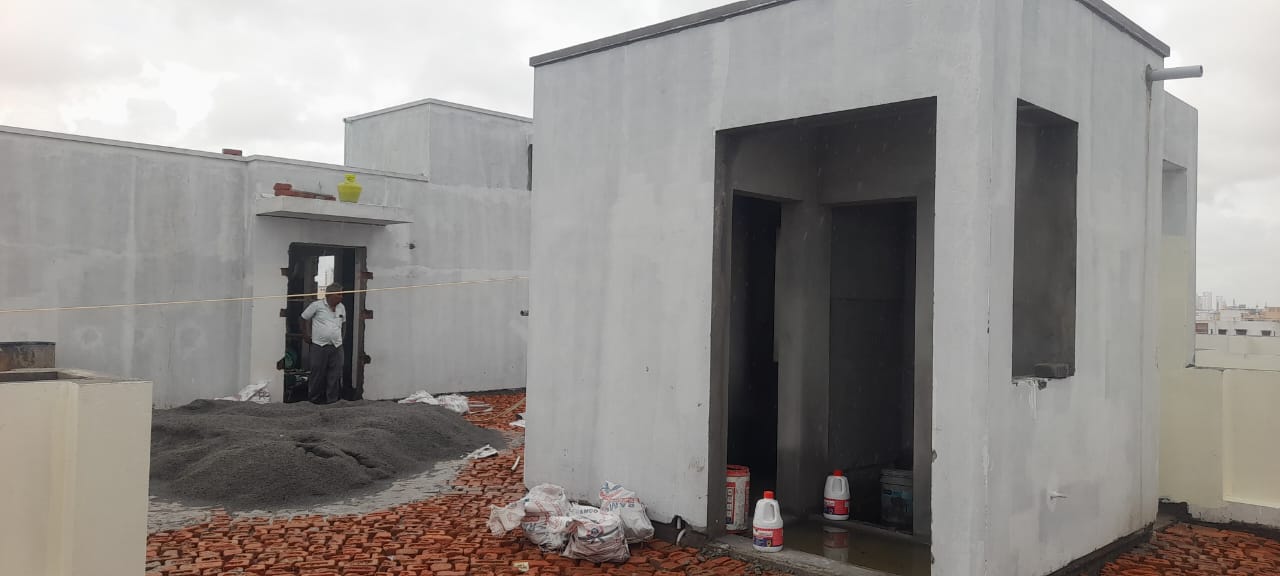

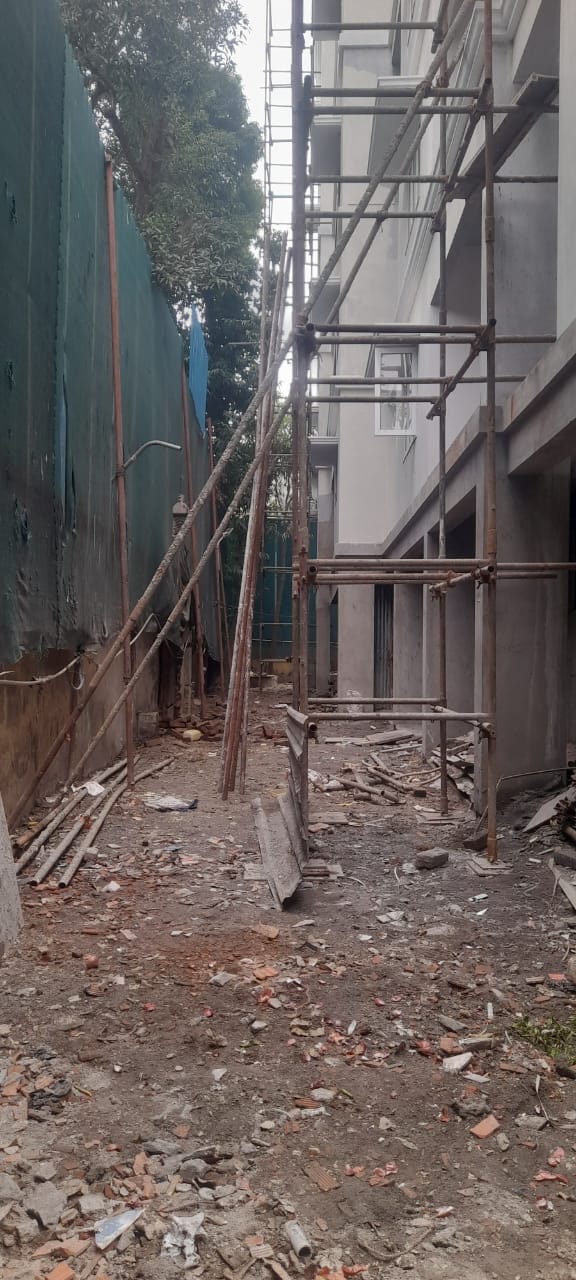

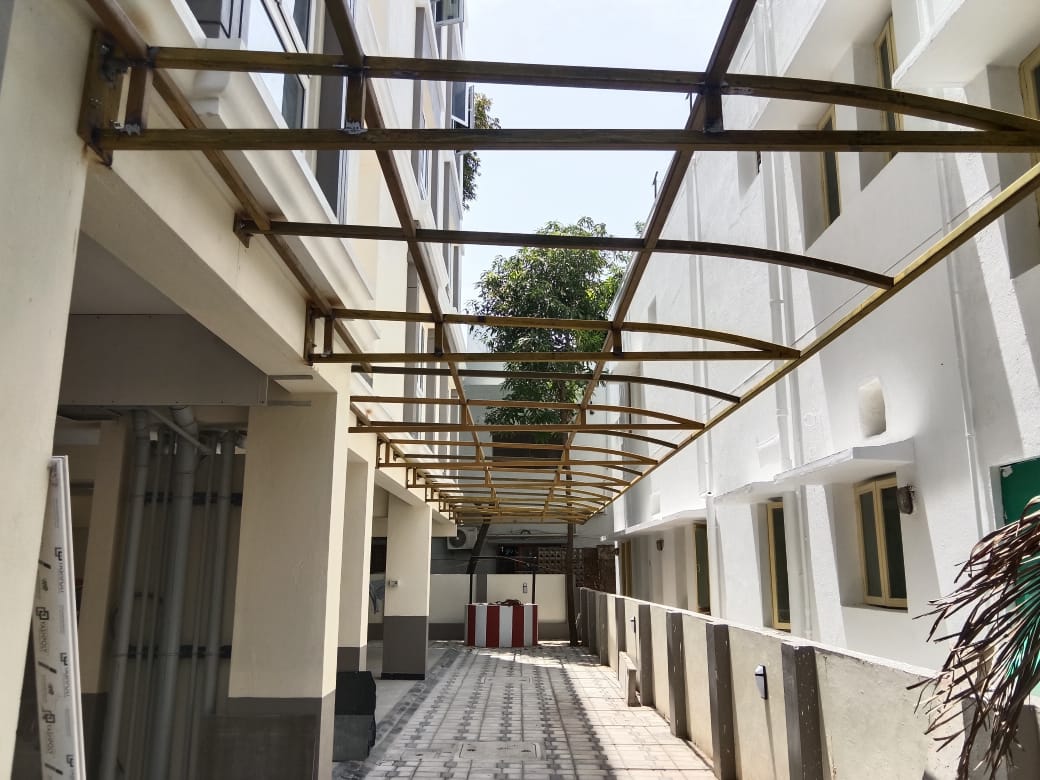

  • 5th floor inner plastering work is in progress.(60% completed)

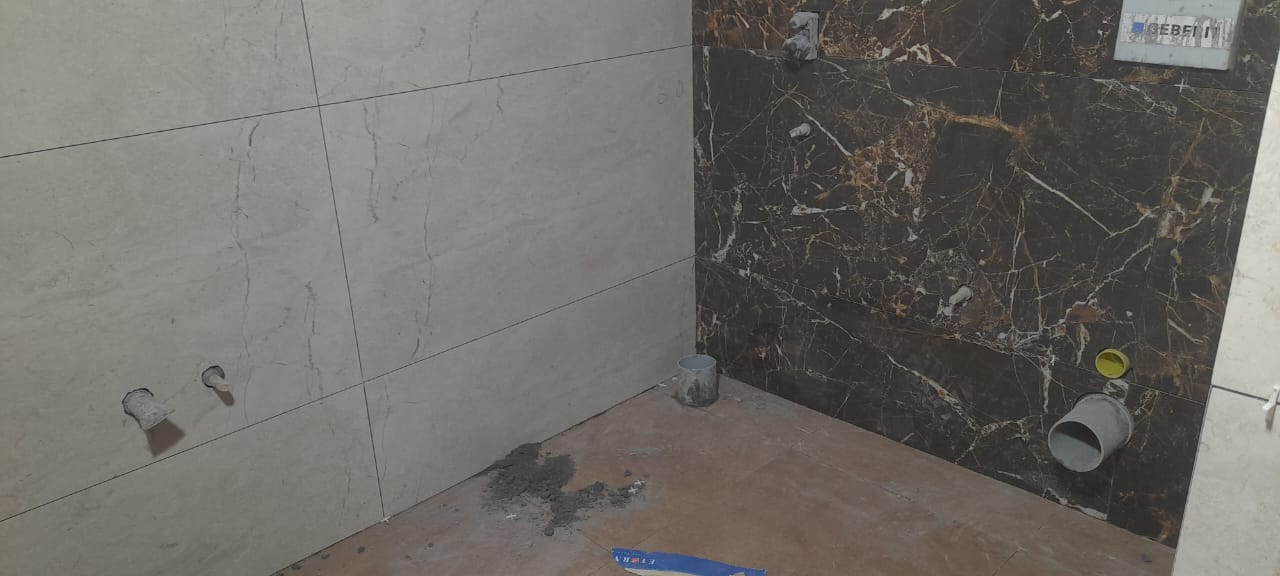

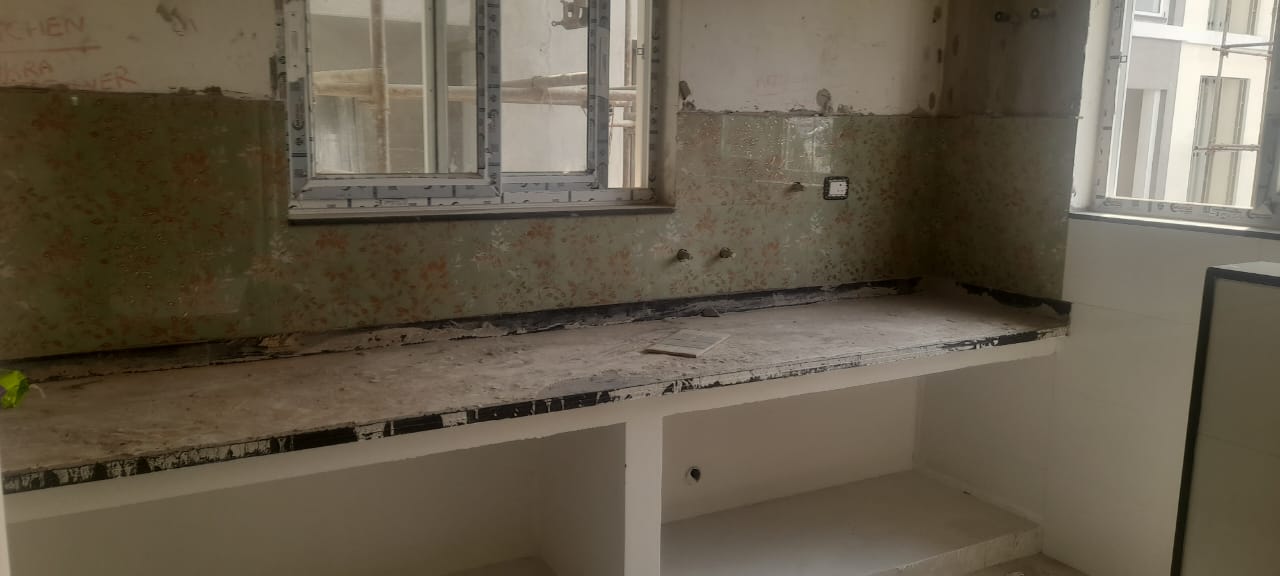

  • 4th& 5thfloor toilet wall tile laying work is in progress.(upto 3rd floor completed)

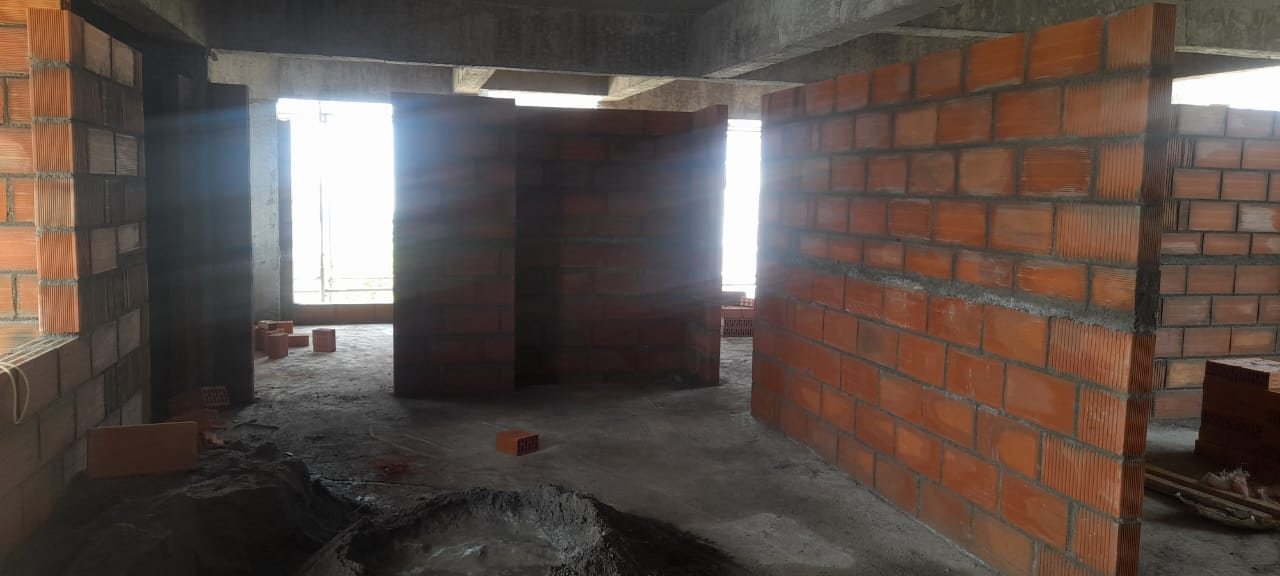

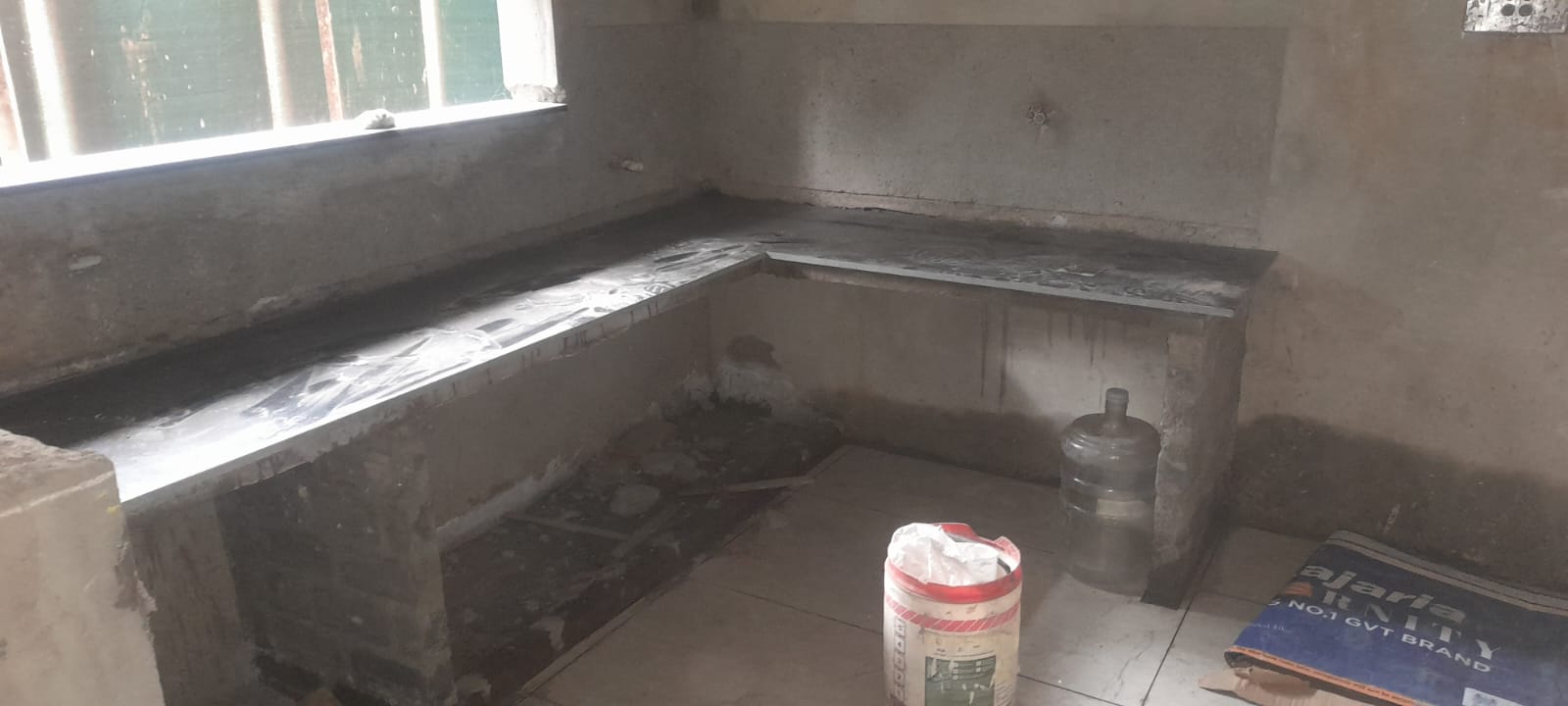

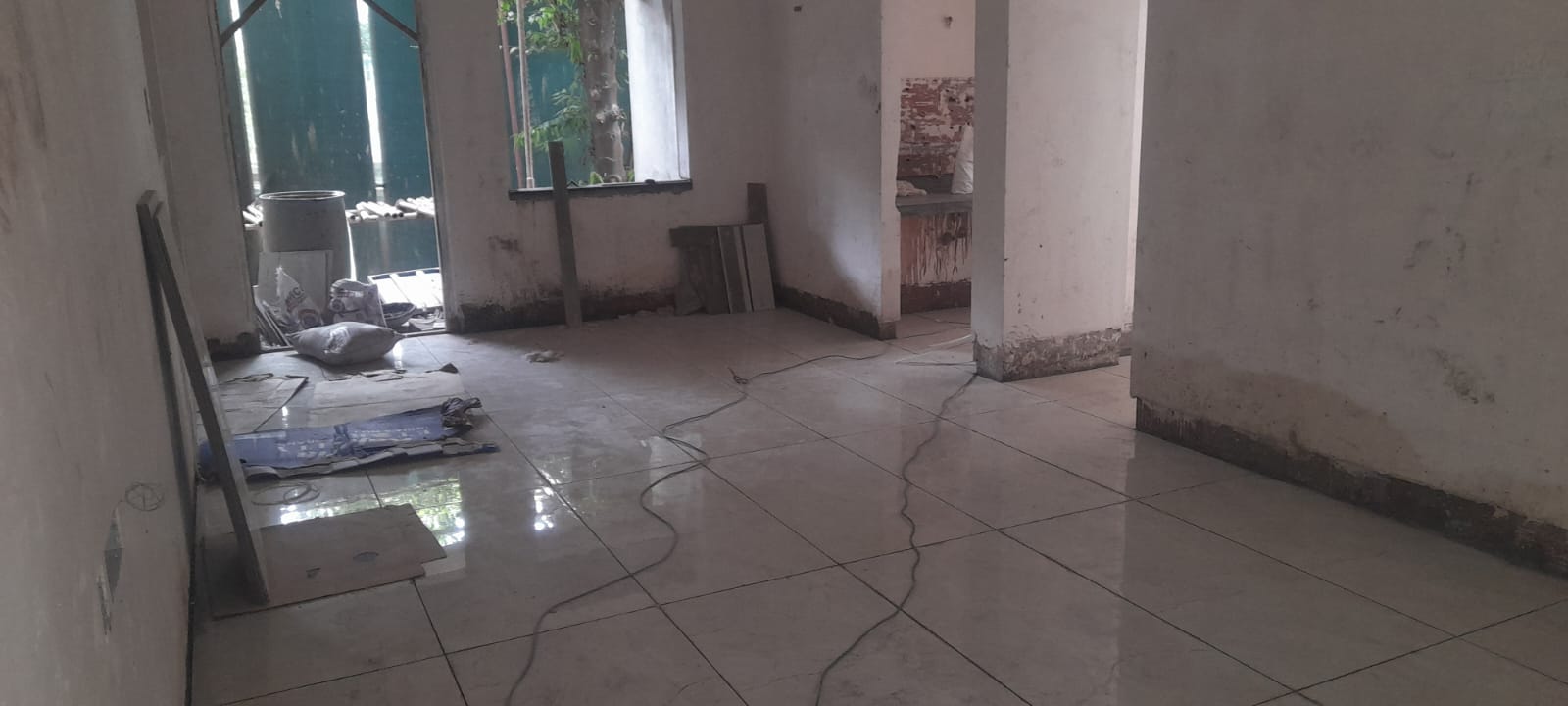

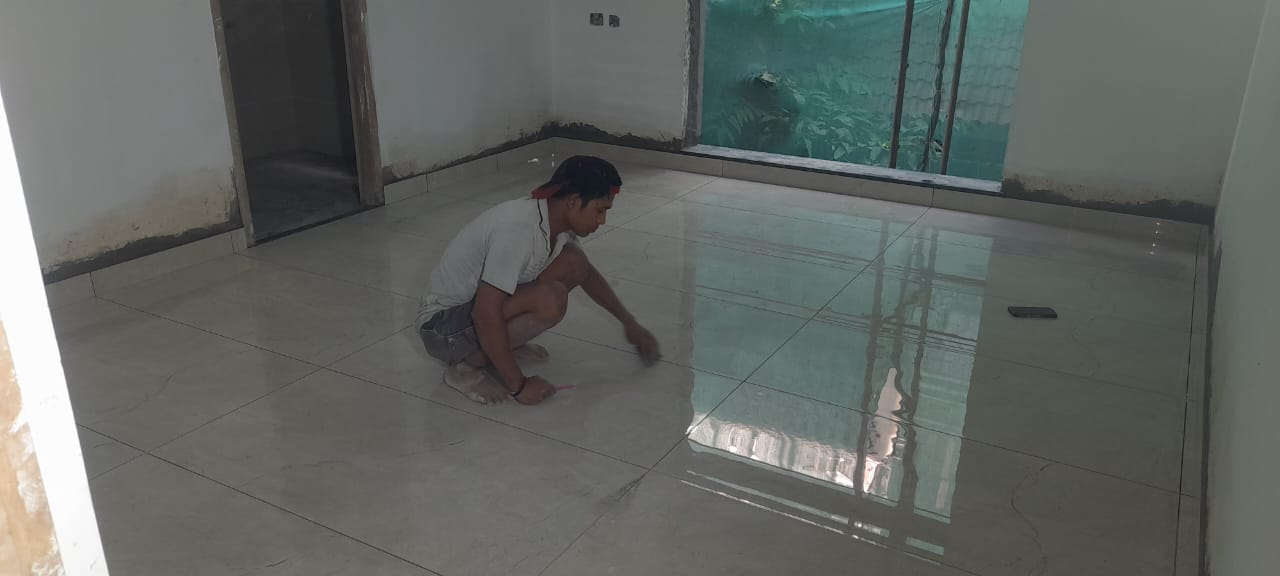

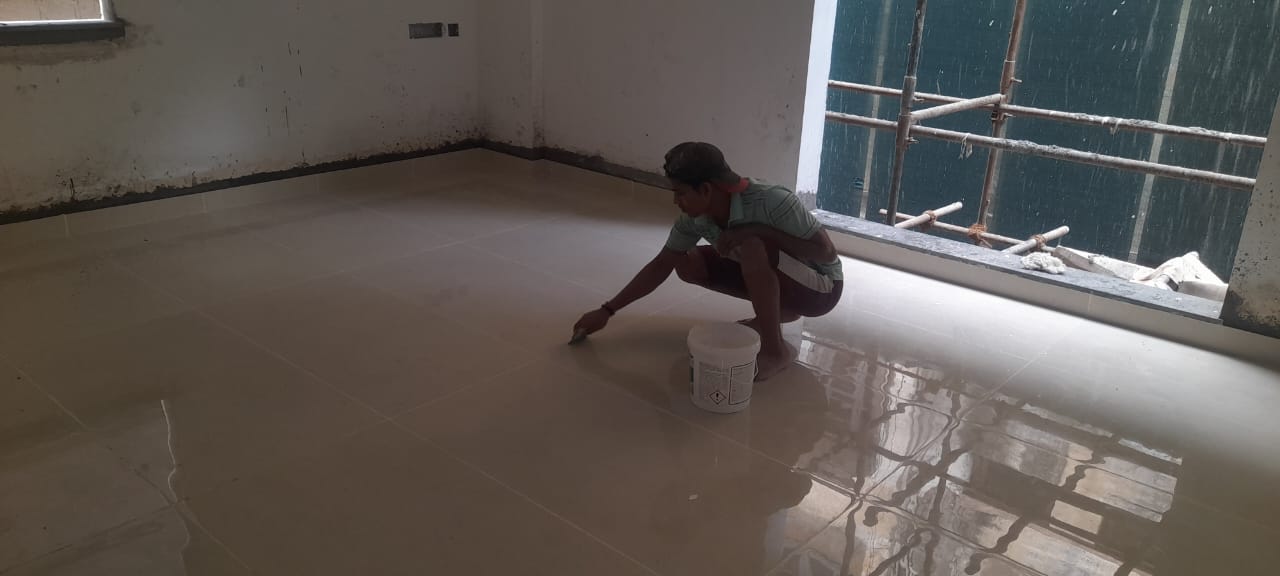

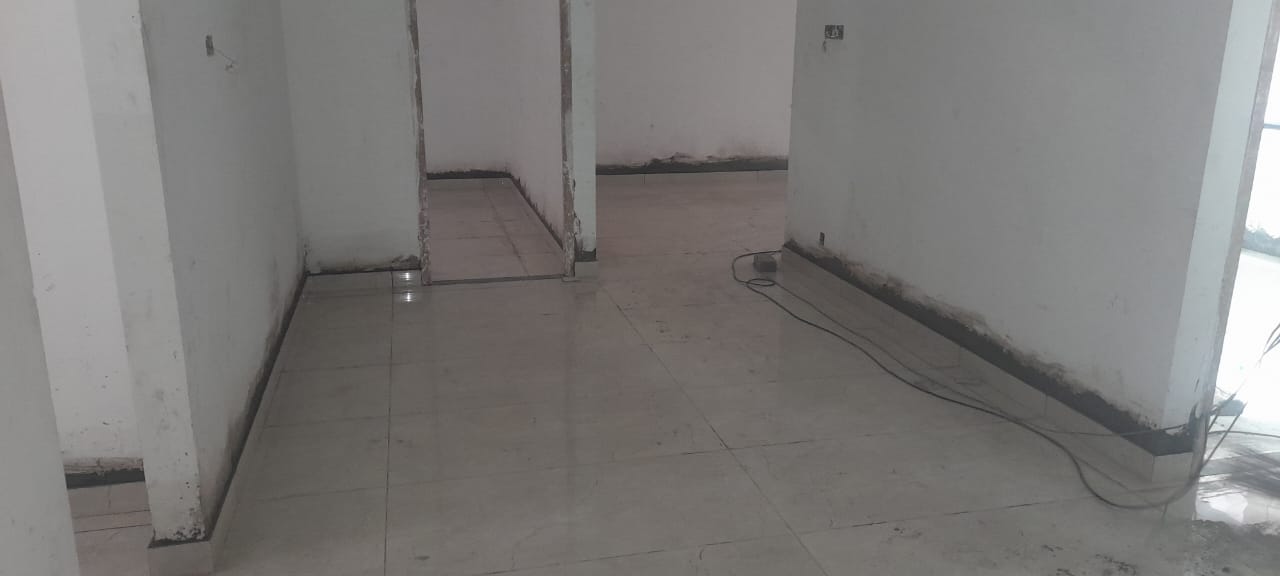

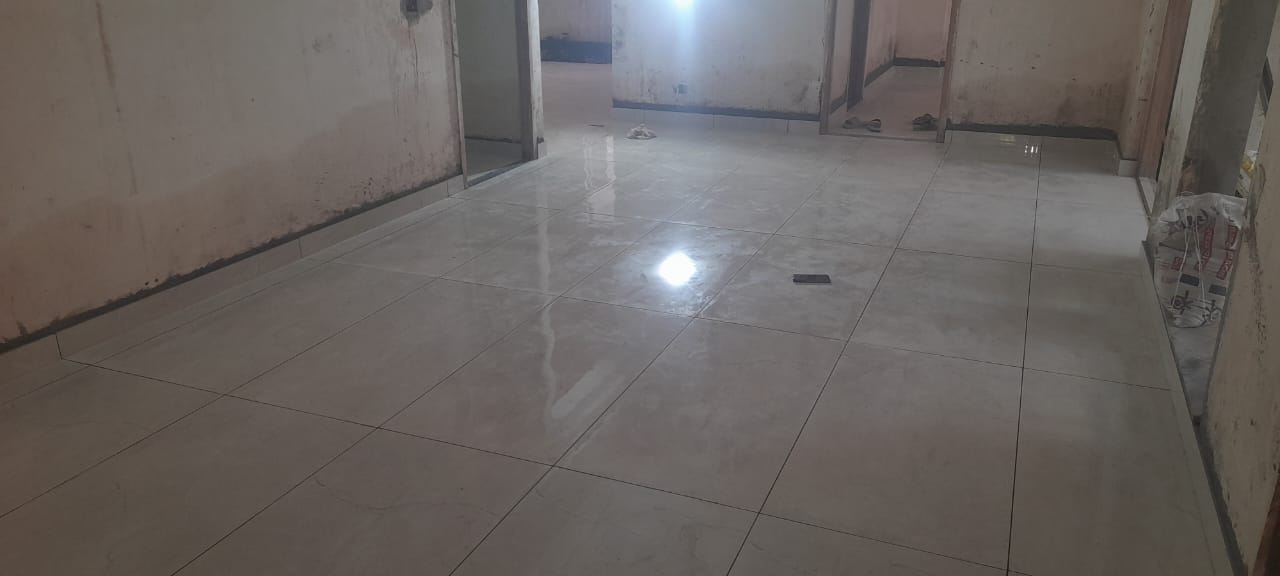

  • General floor work is in progress (14/25 flat completed)

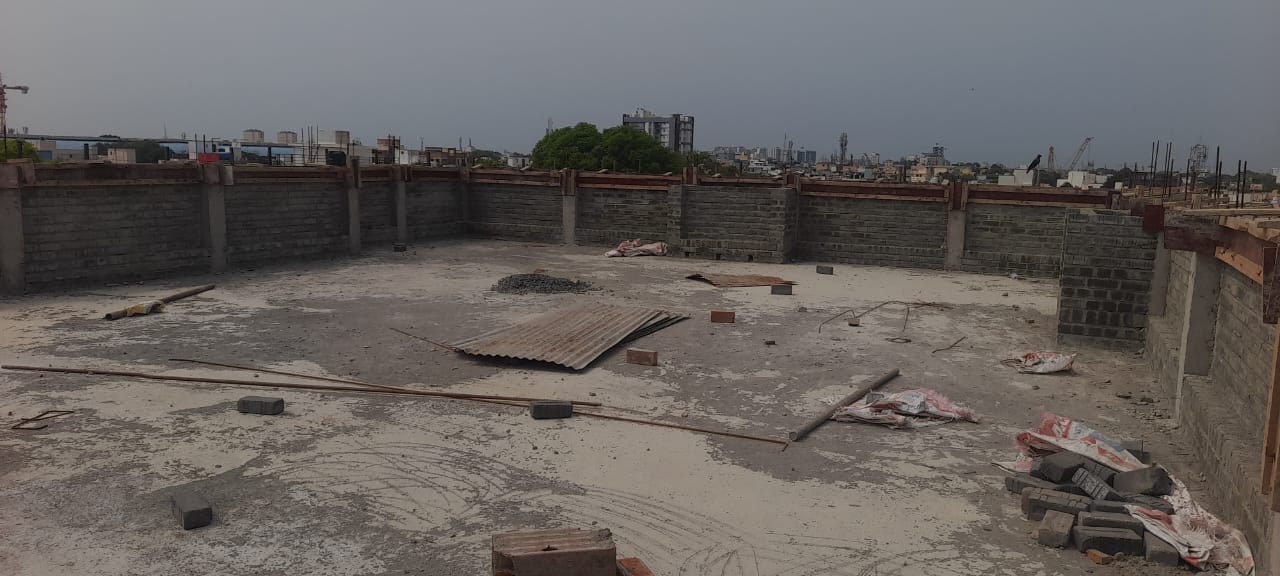

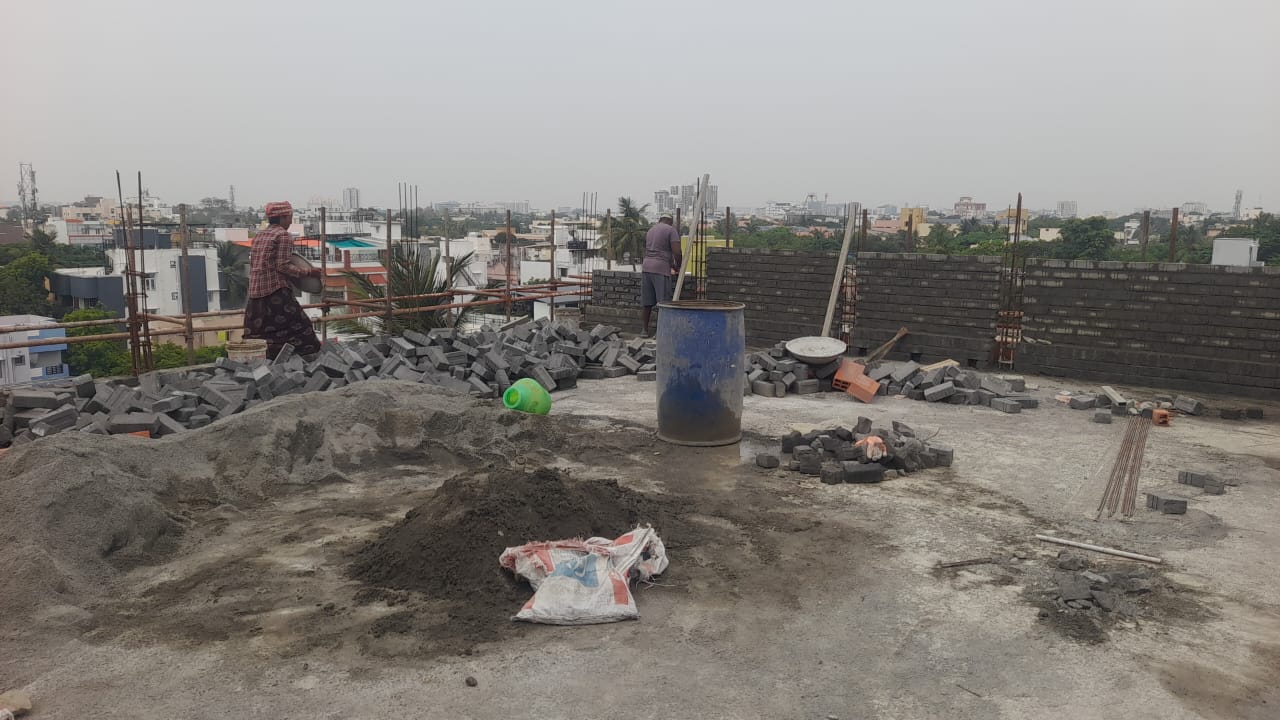

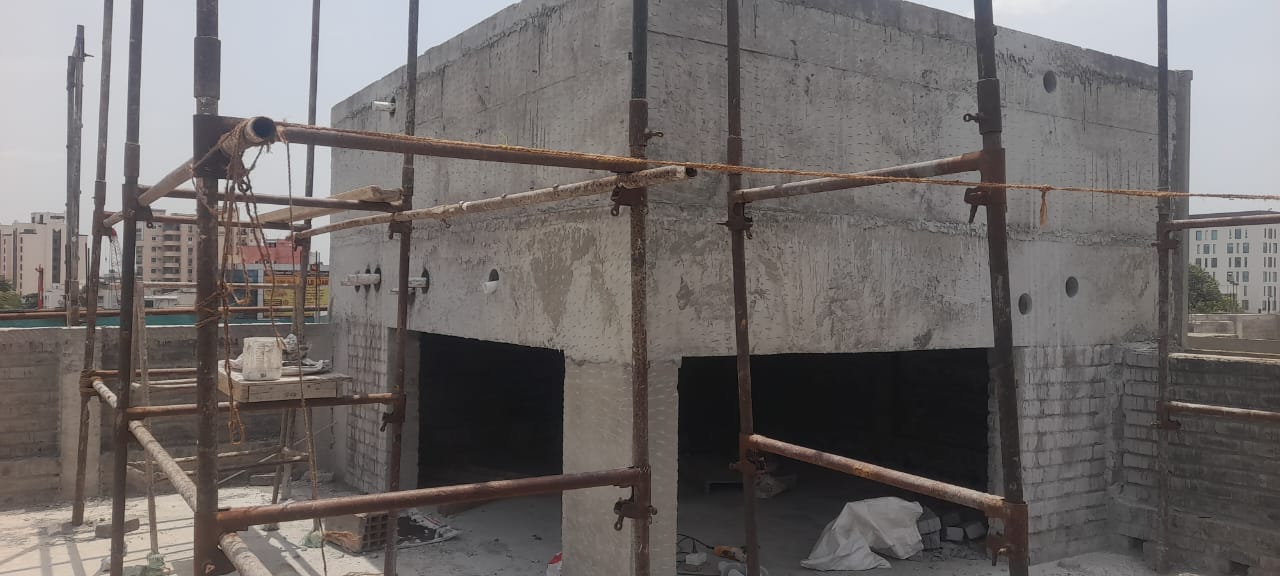

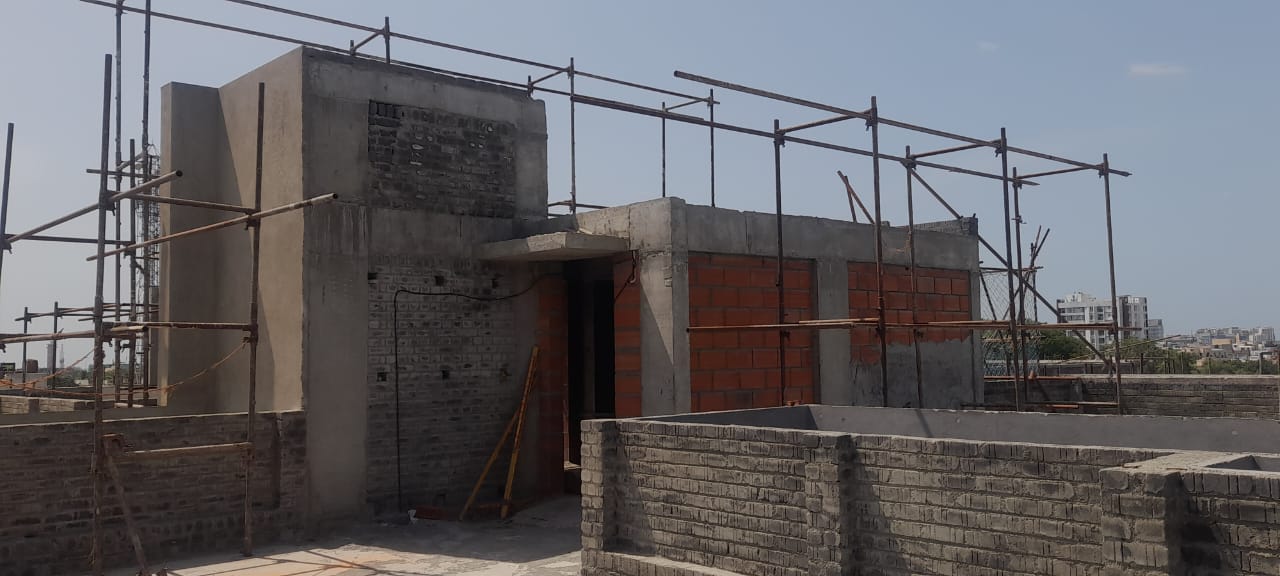

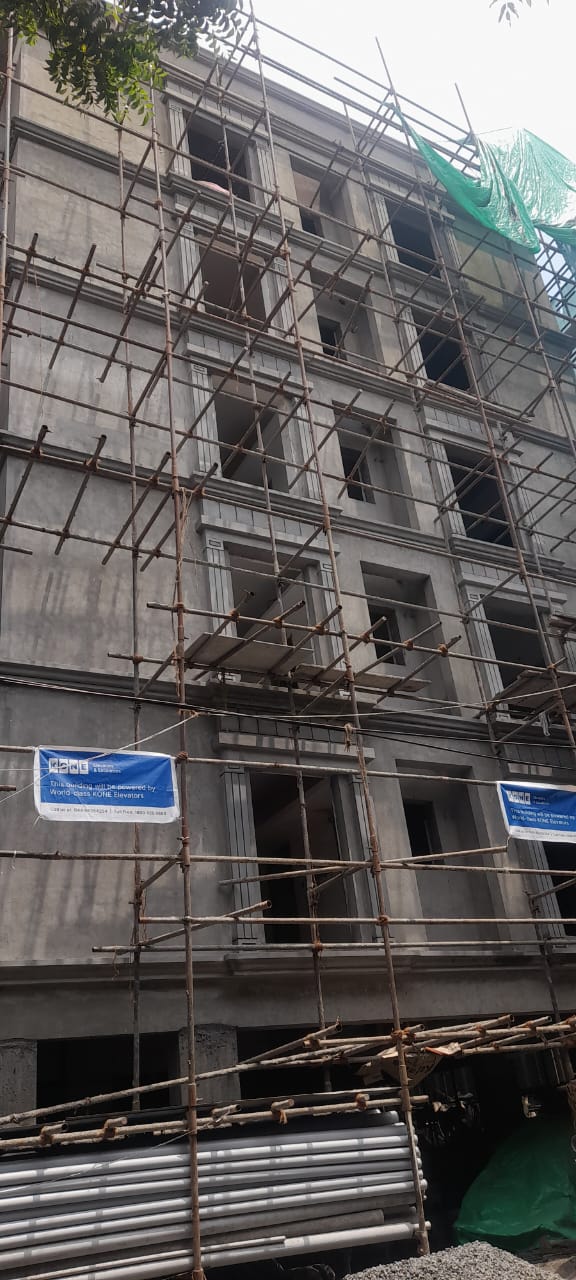

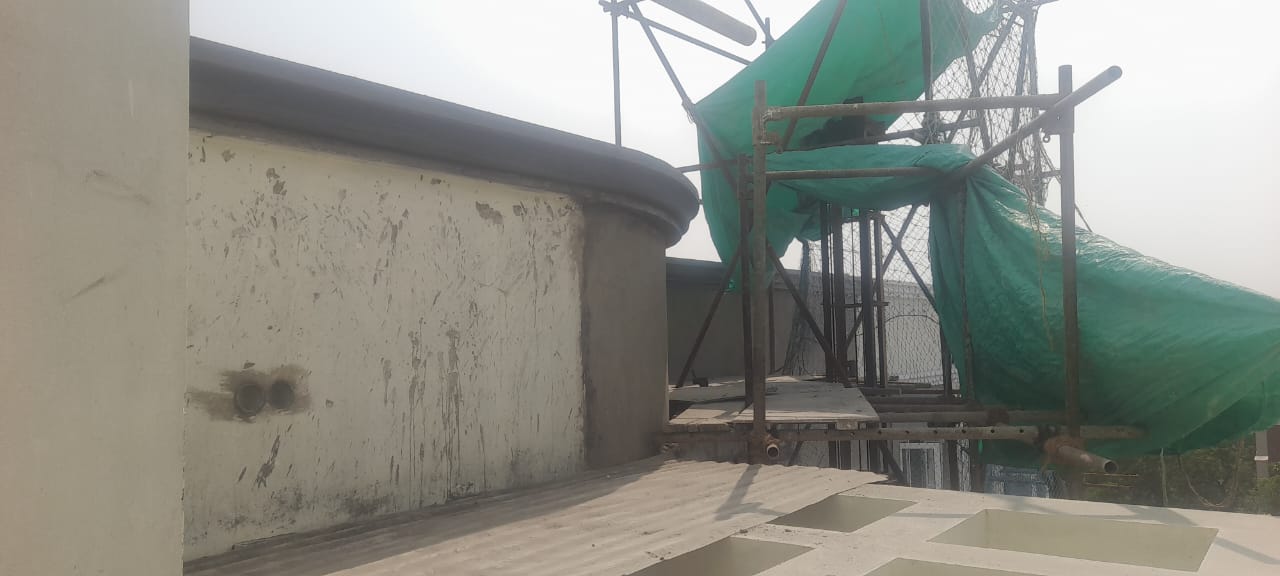

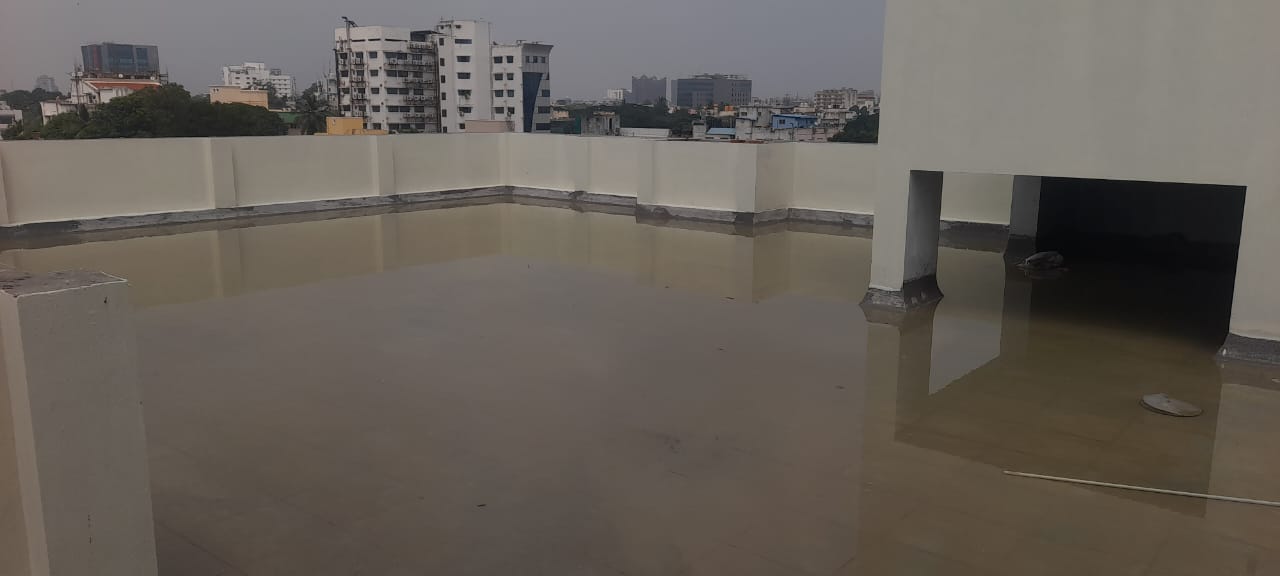

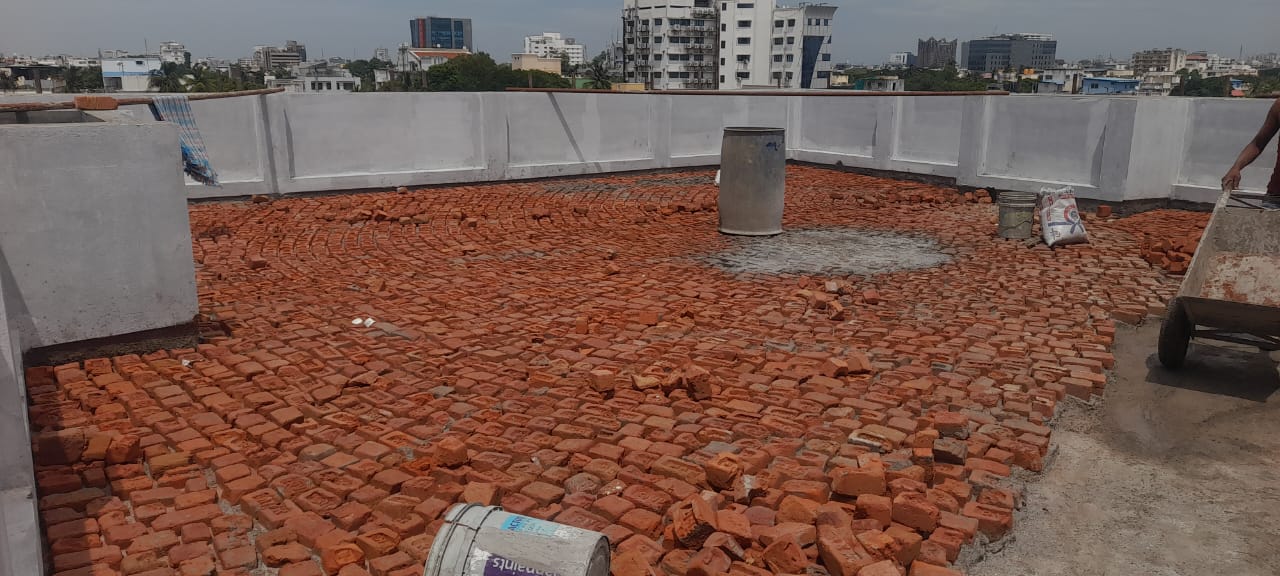

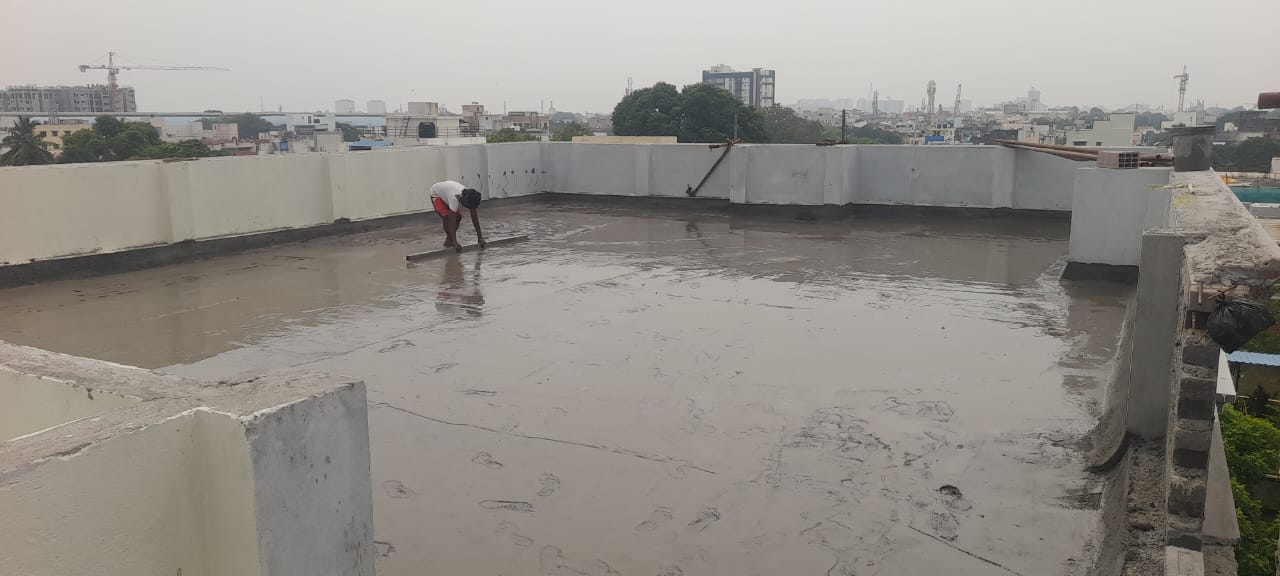

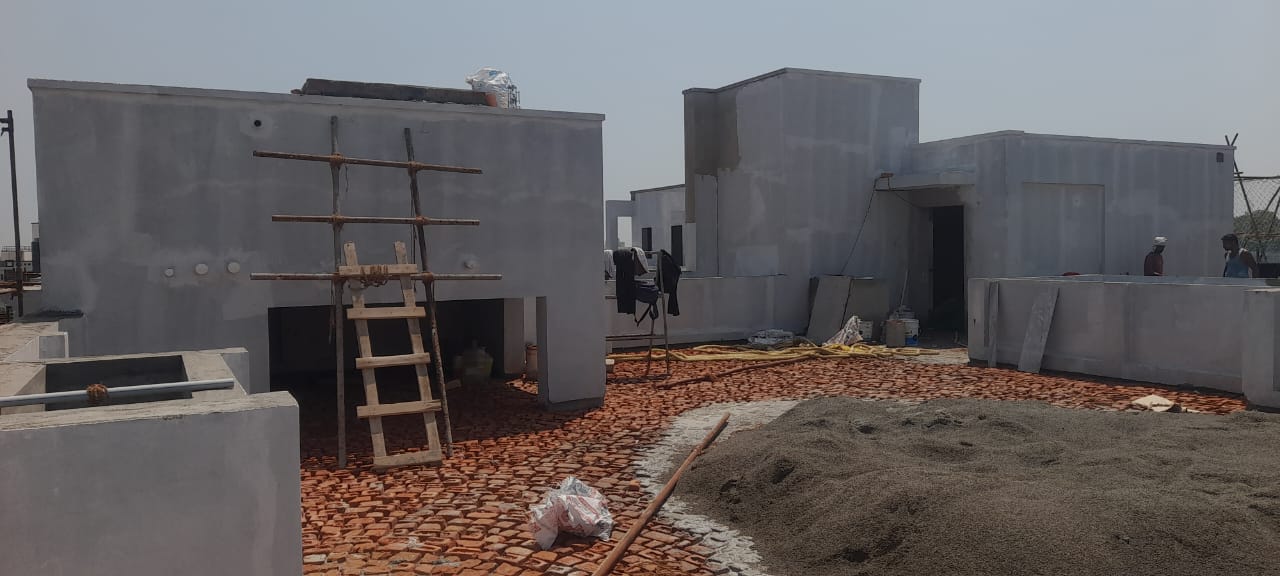

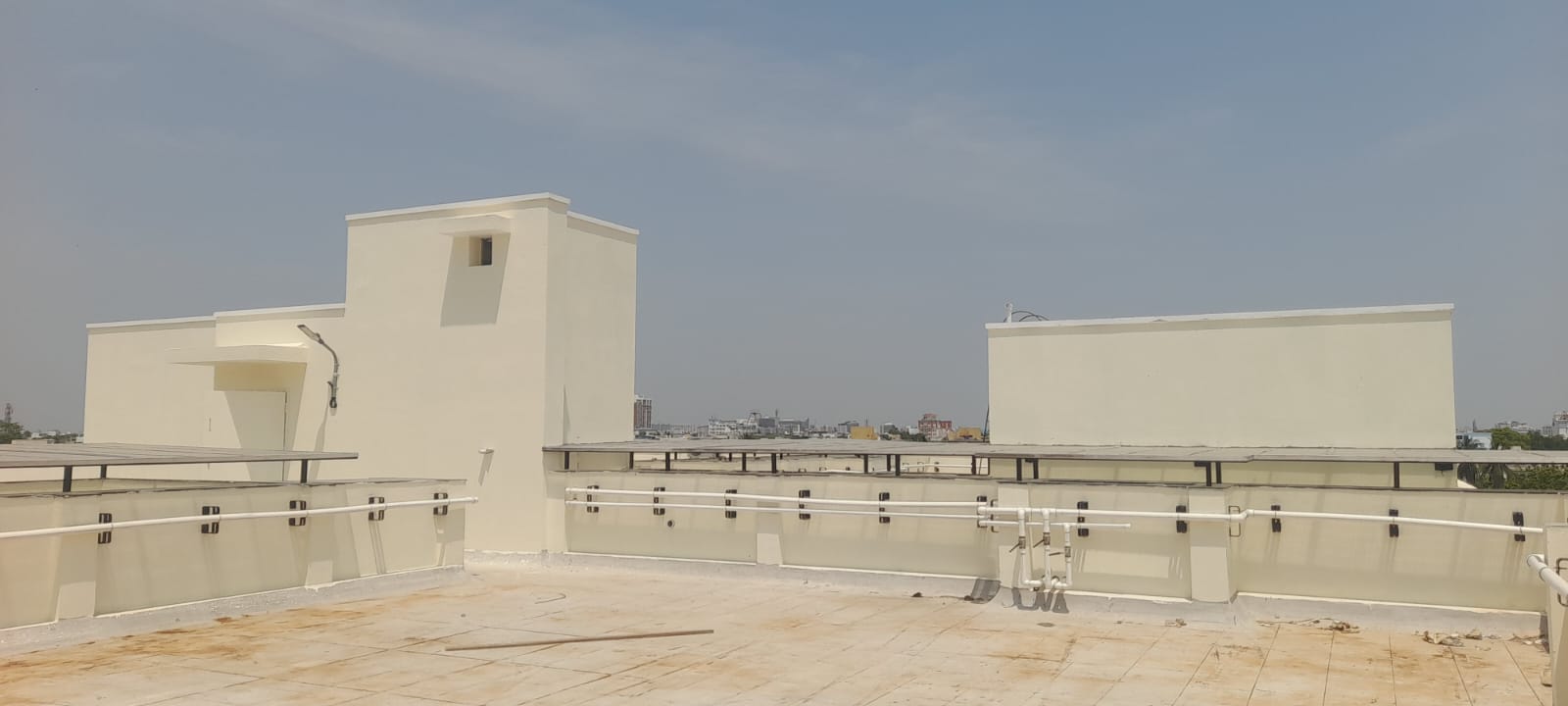

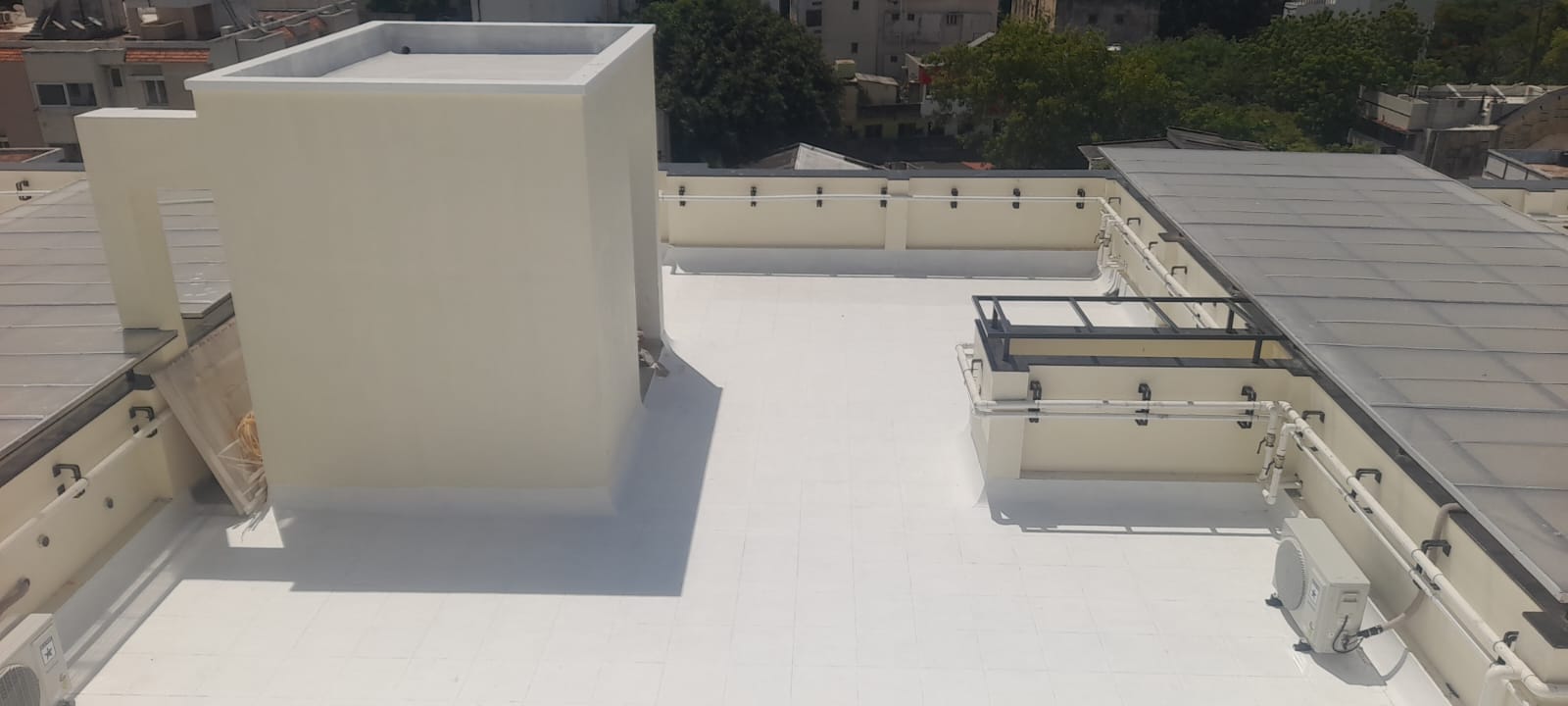

  • Terrace weathering course work is in progress. (60% completed)

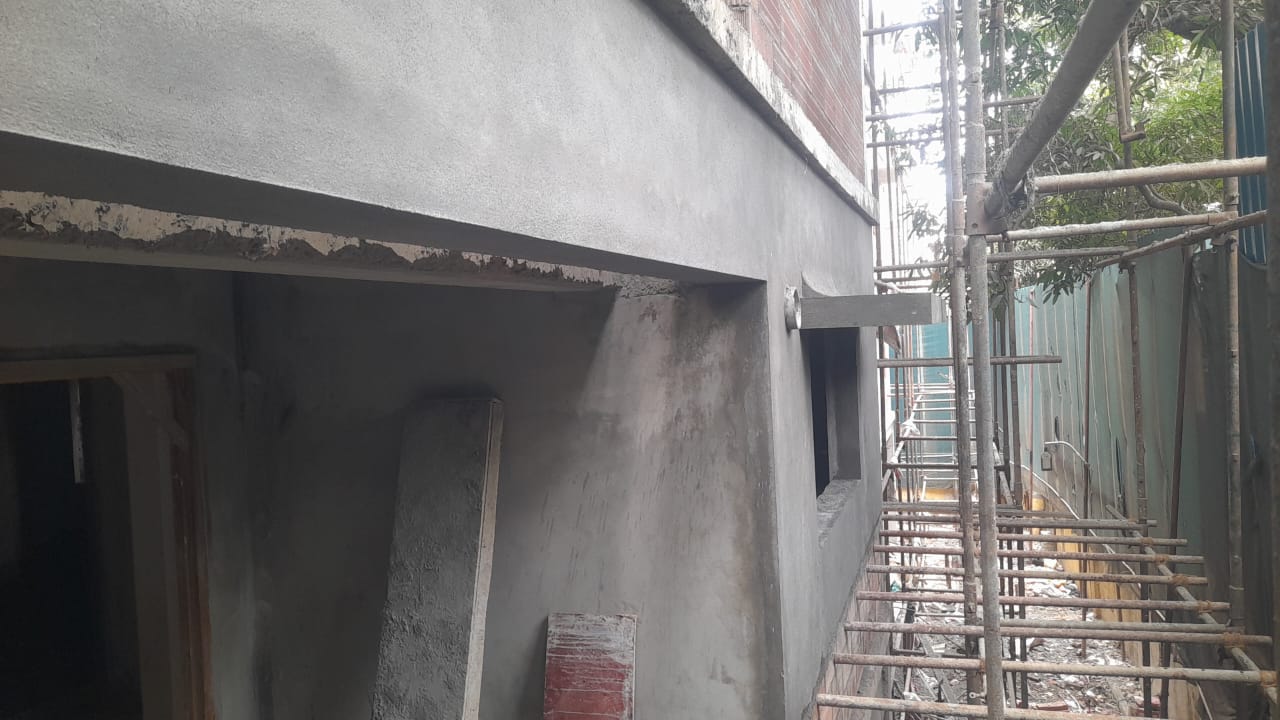

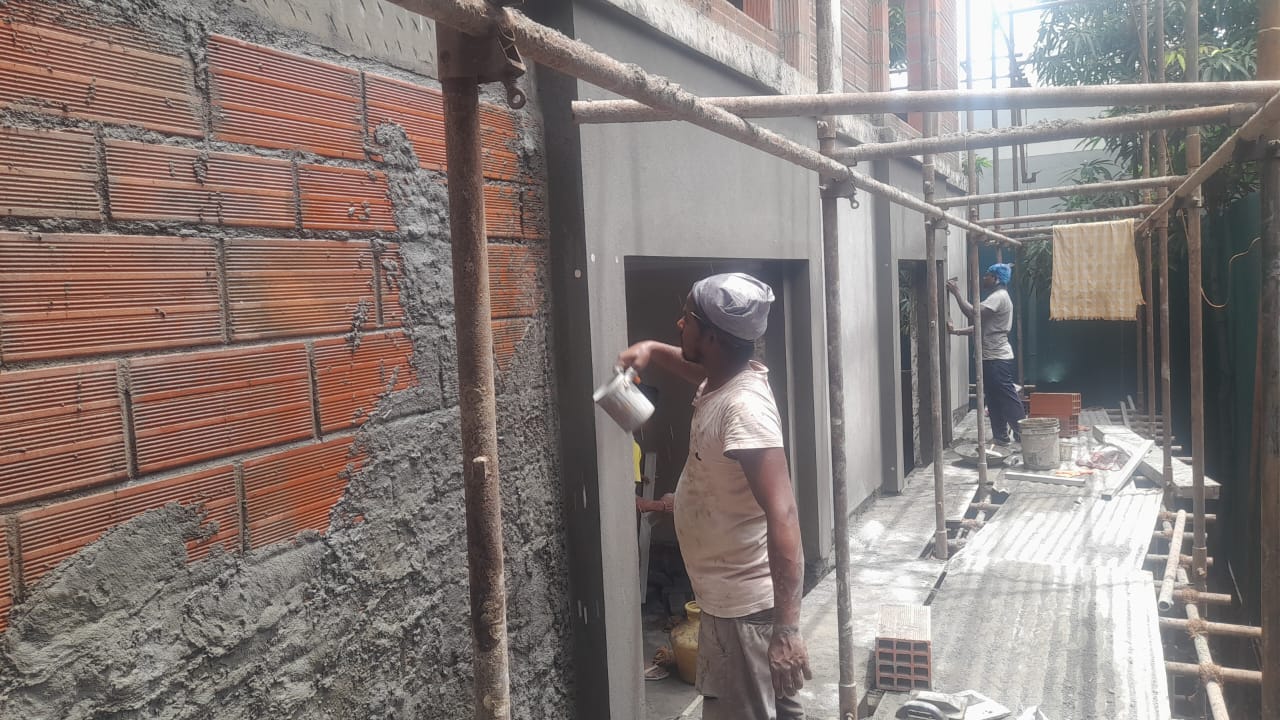

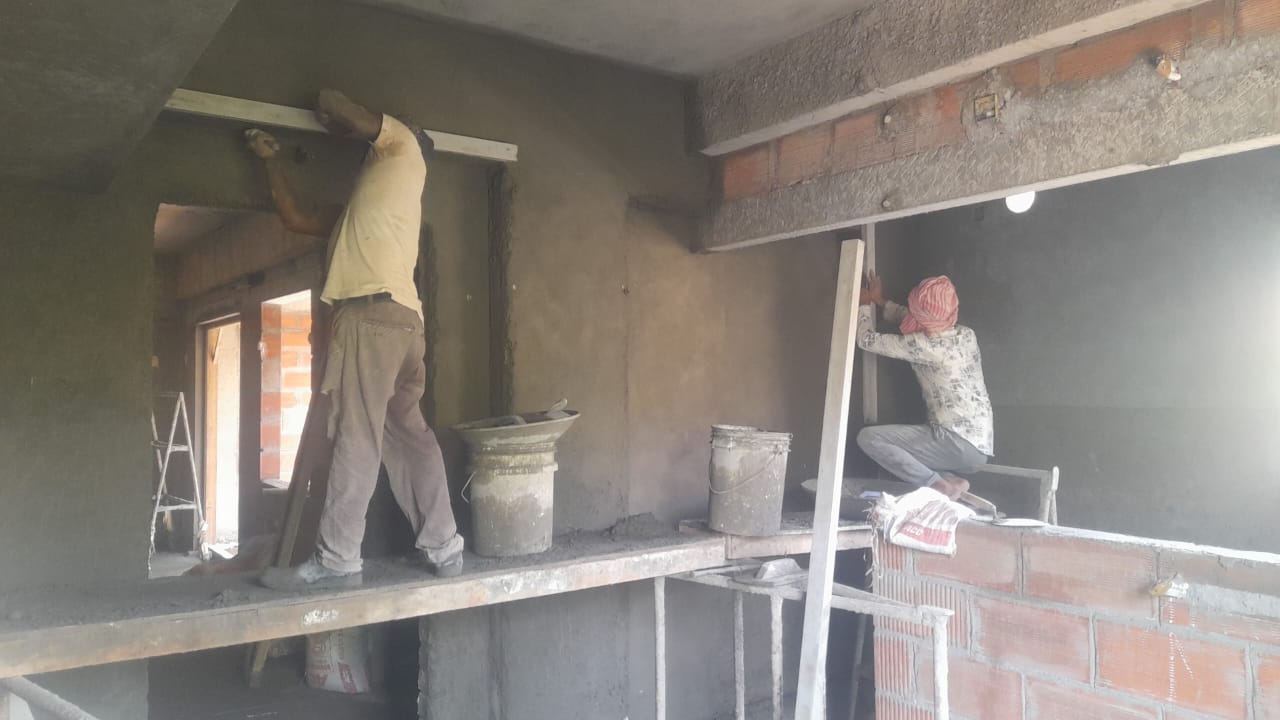

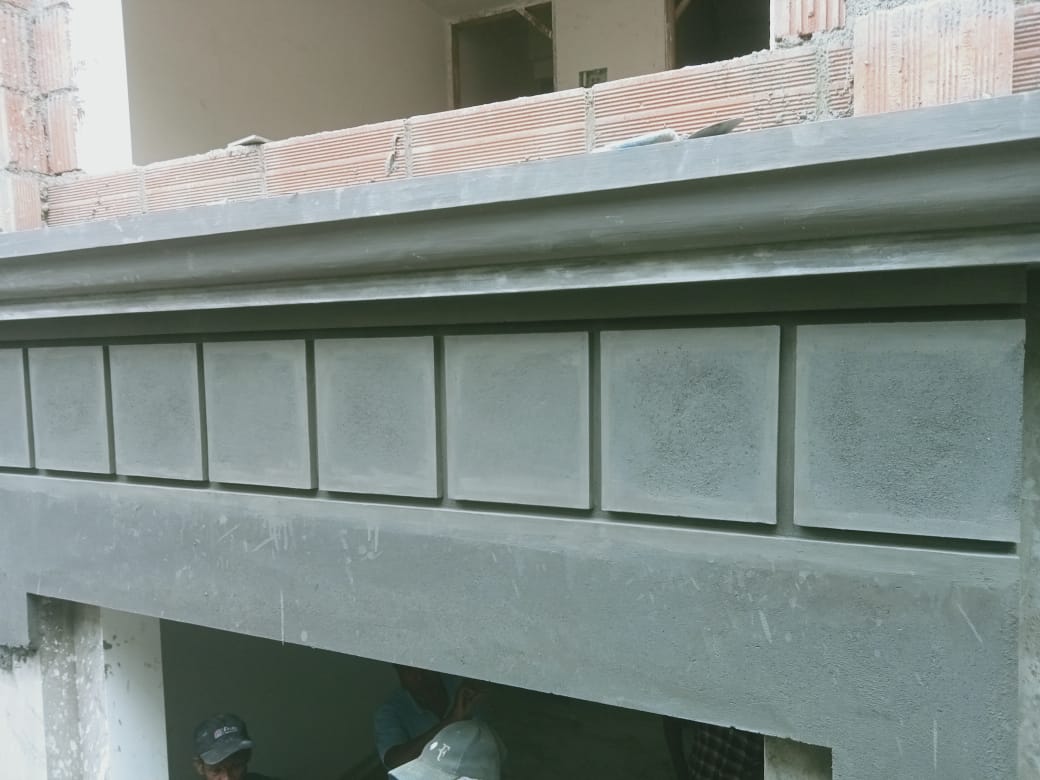

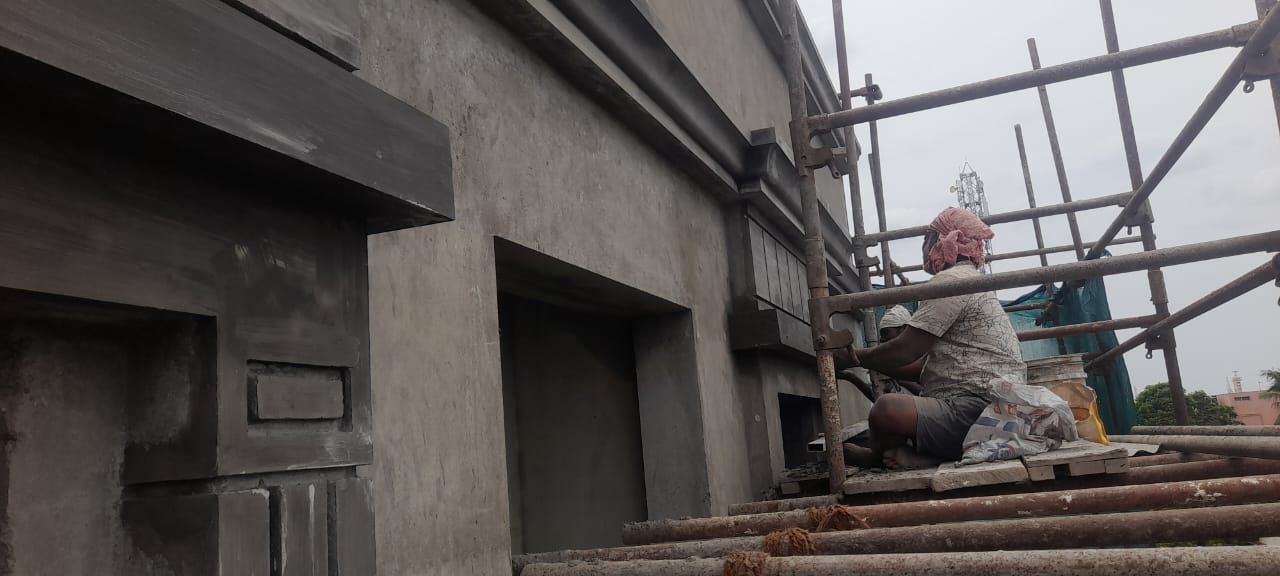

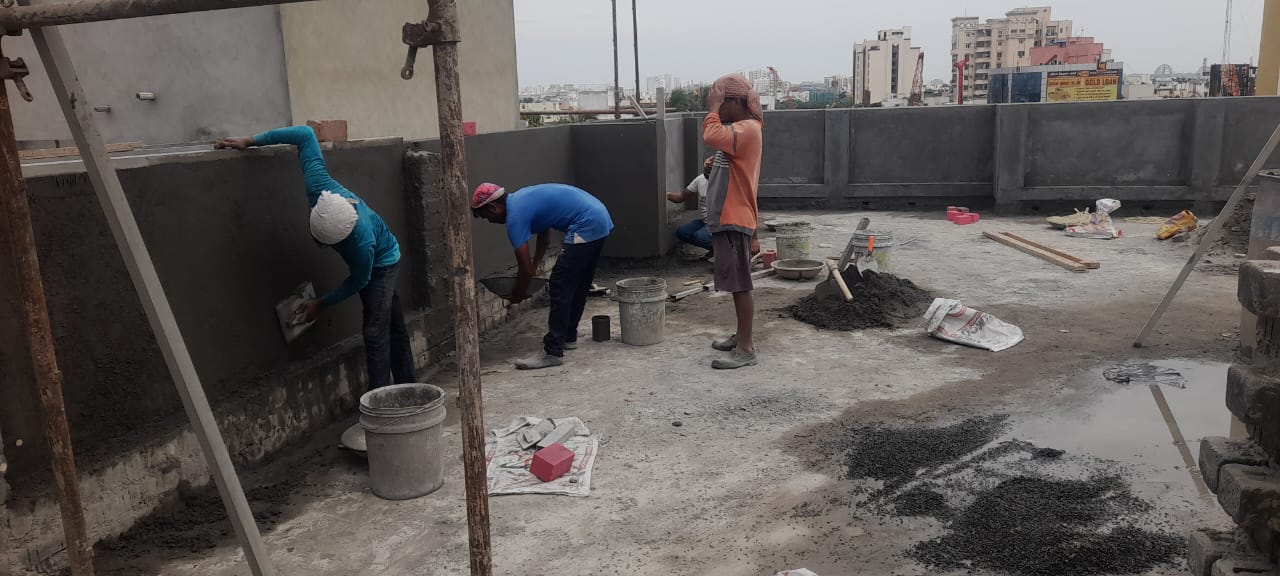

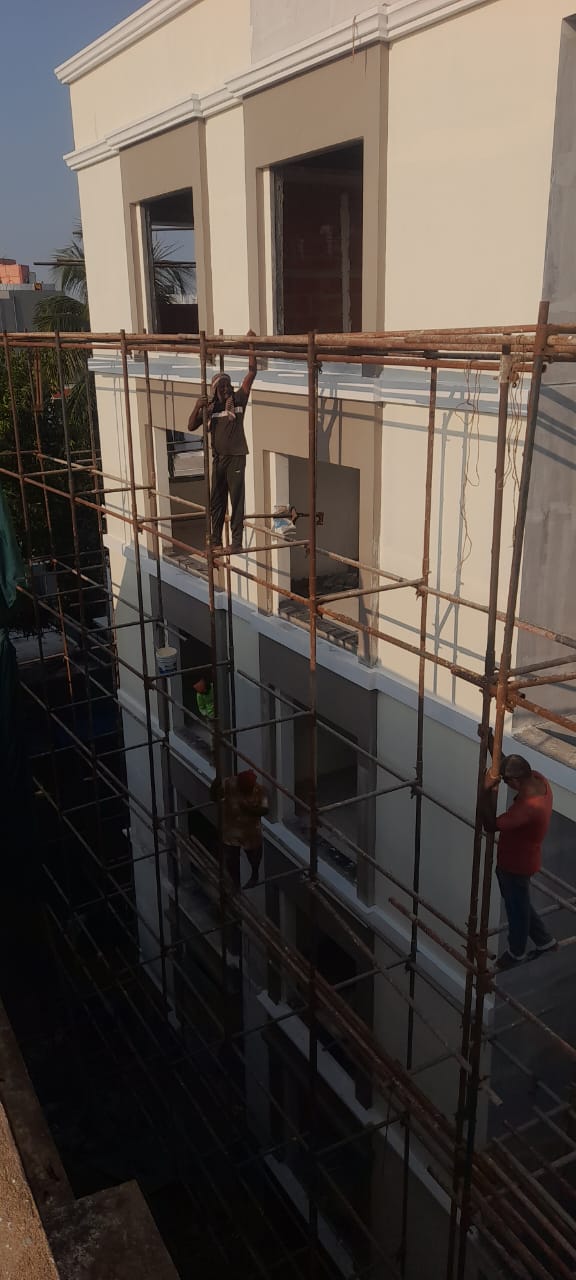

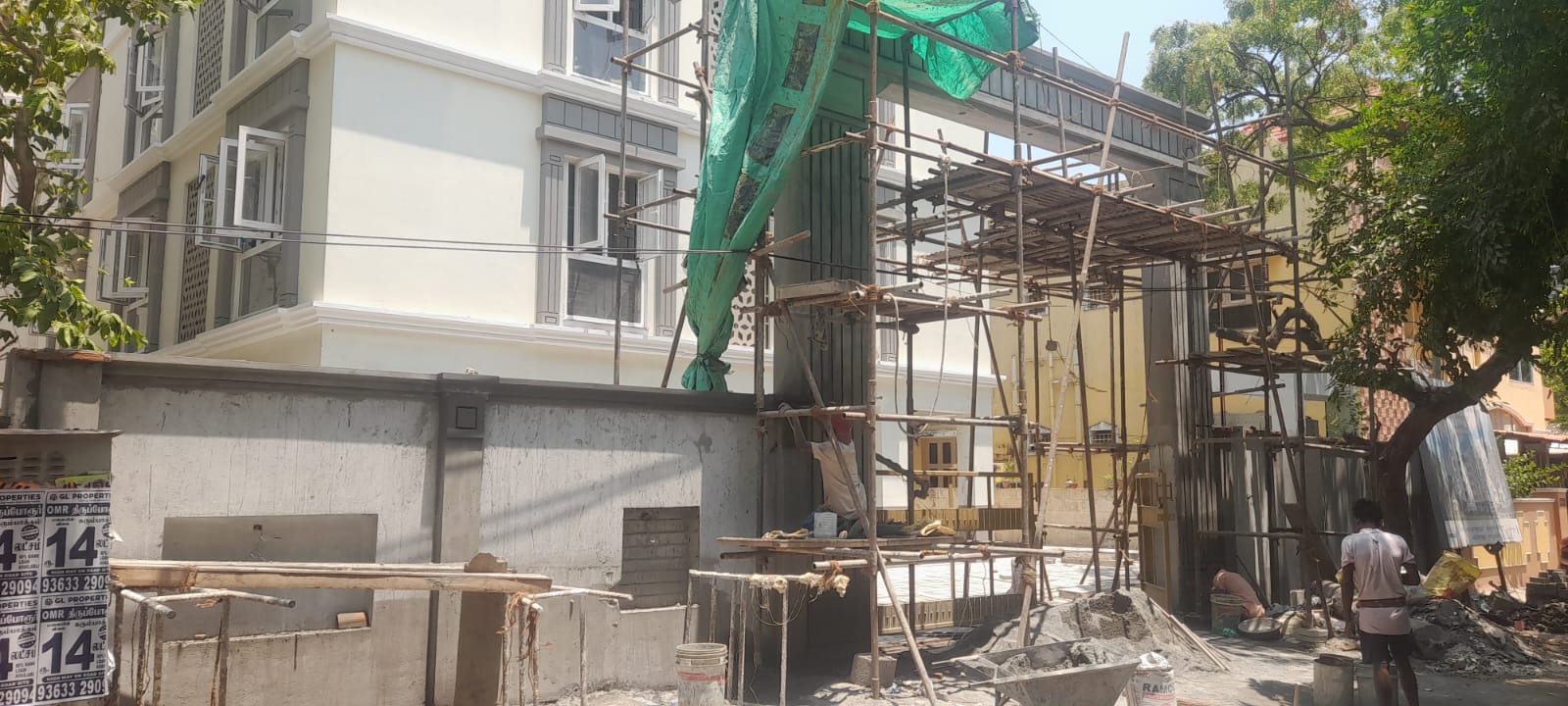

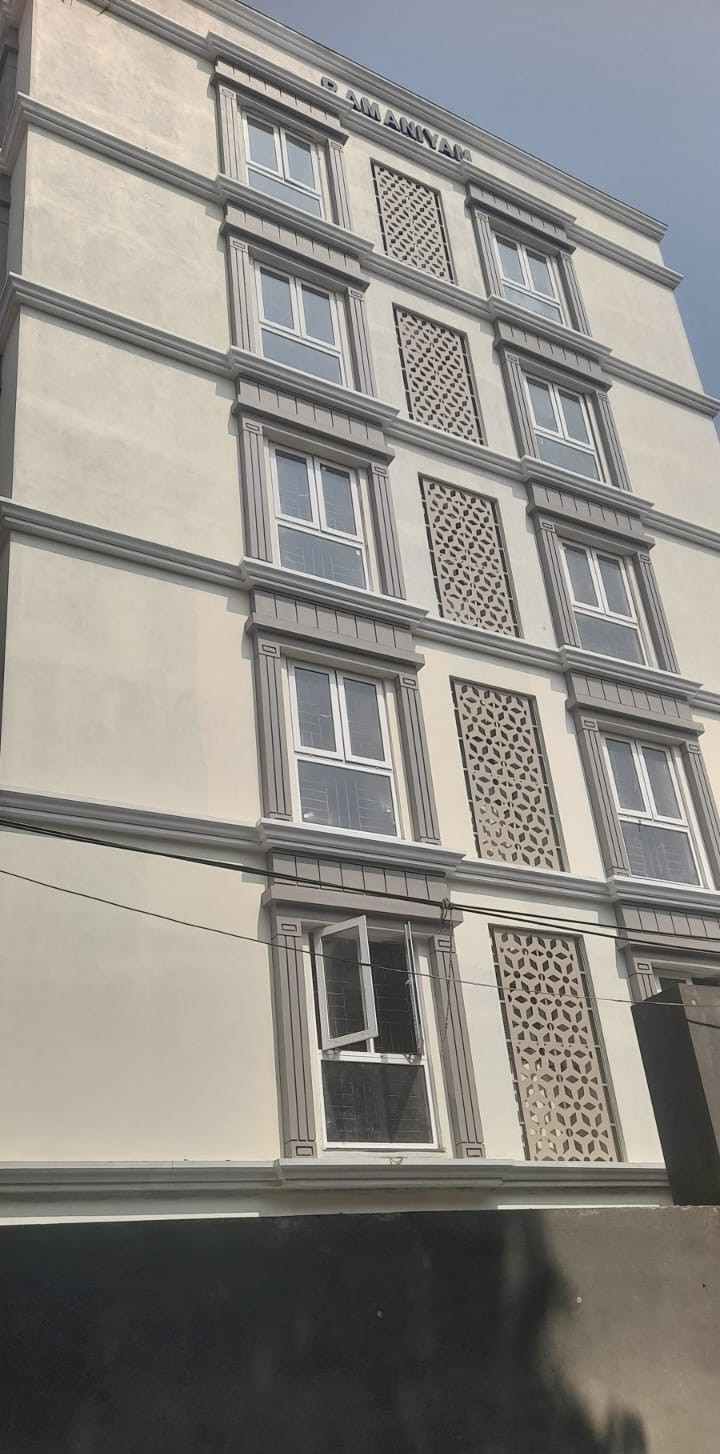

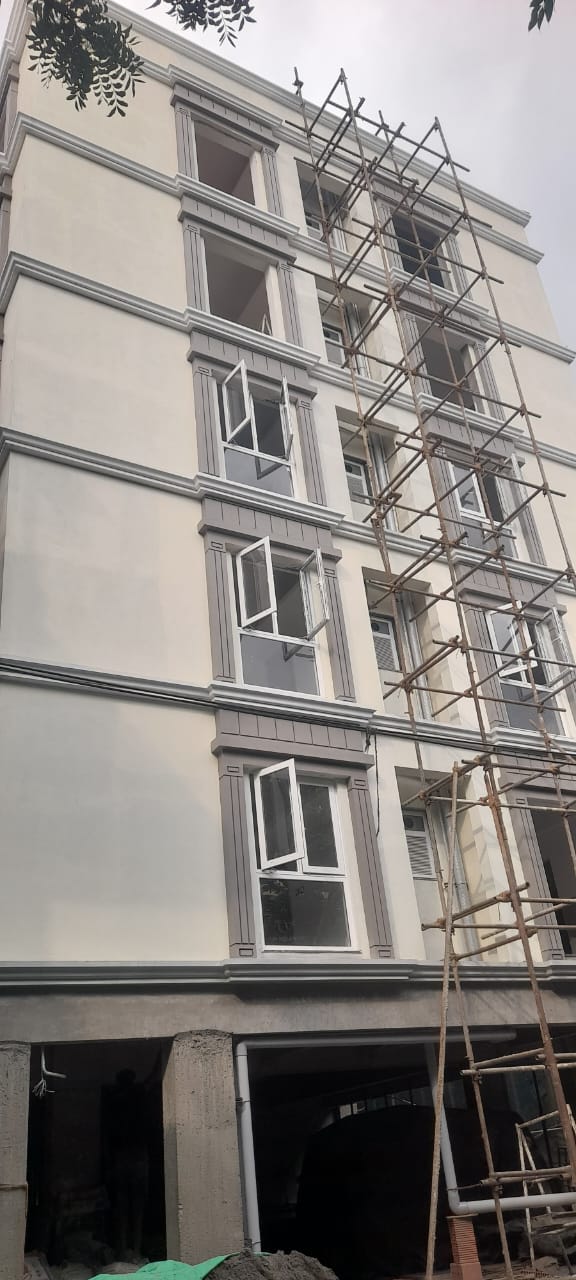

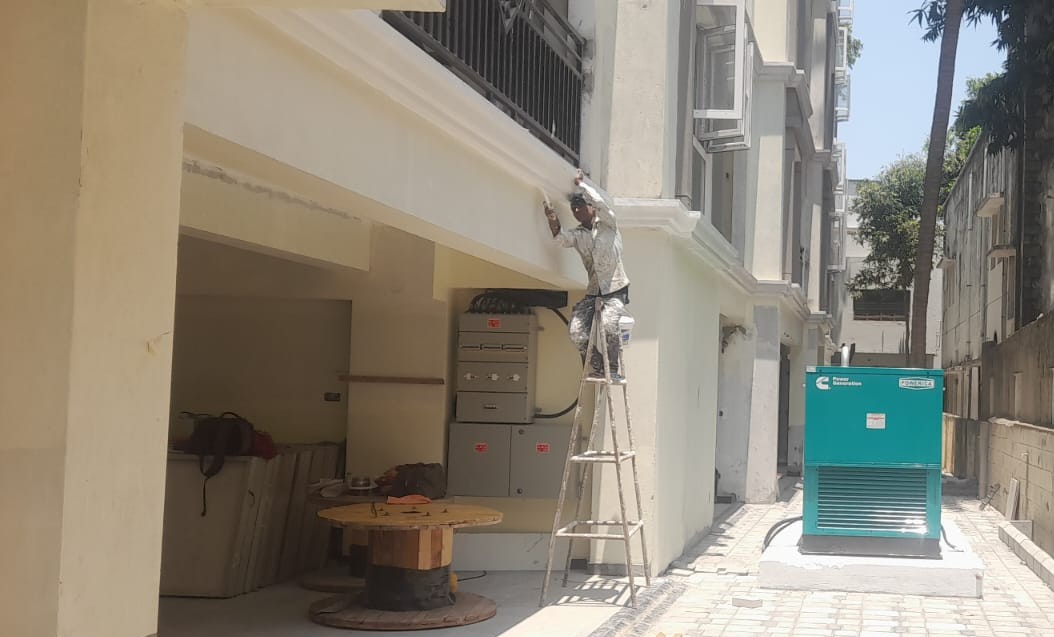

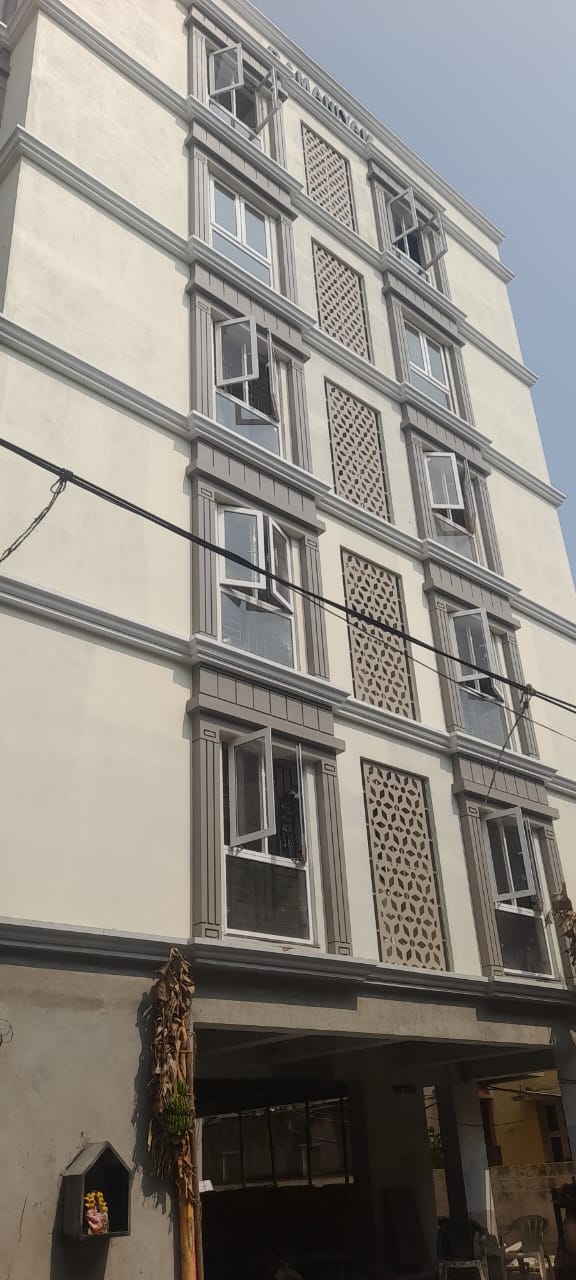

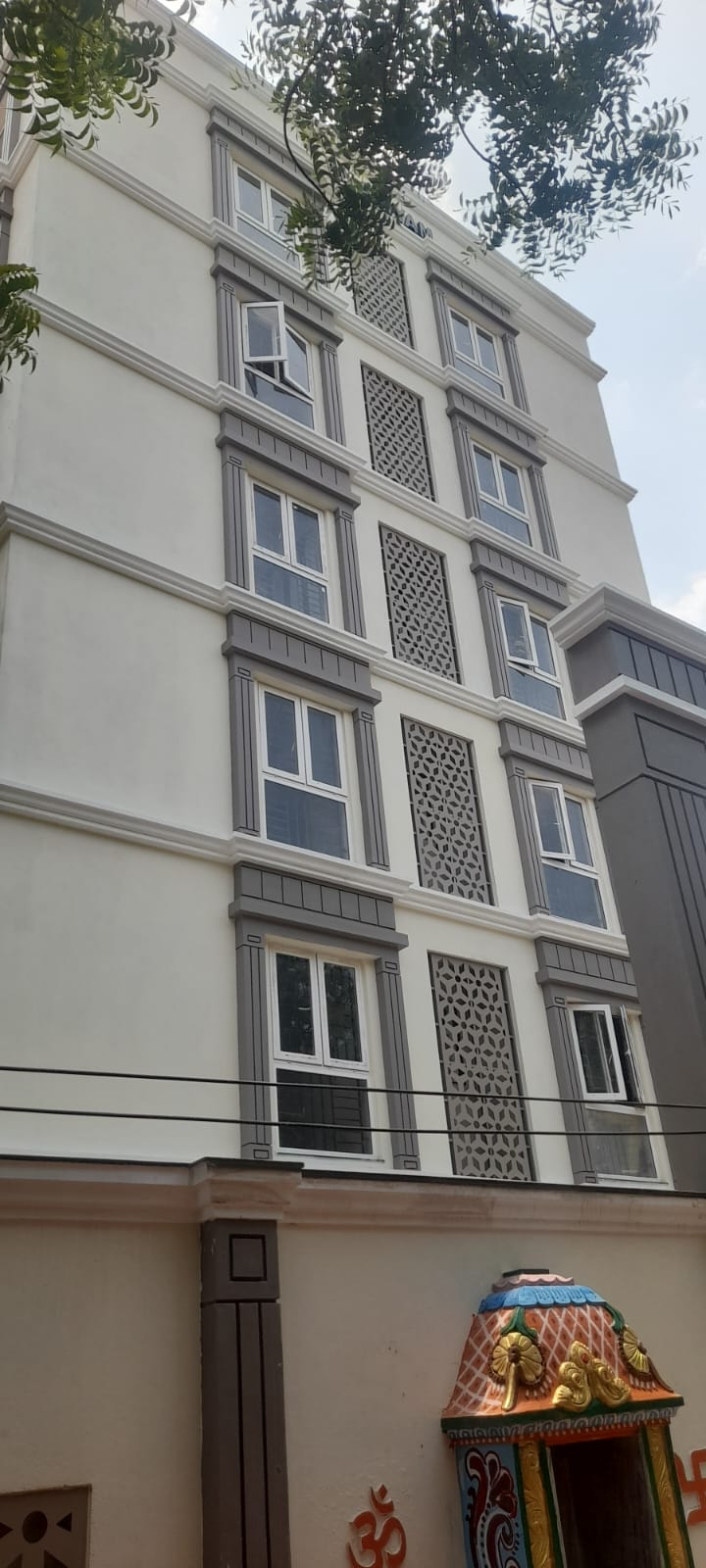

  • External 1st coat painting work is completed.

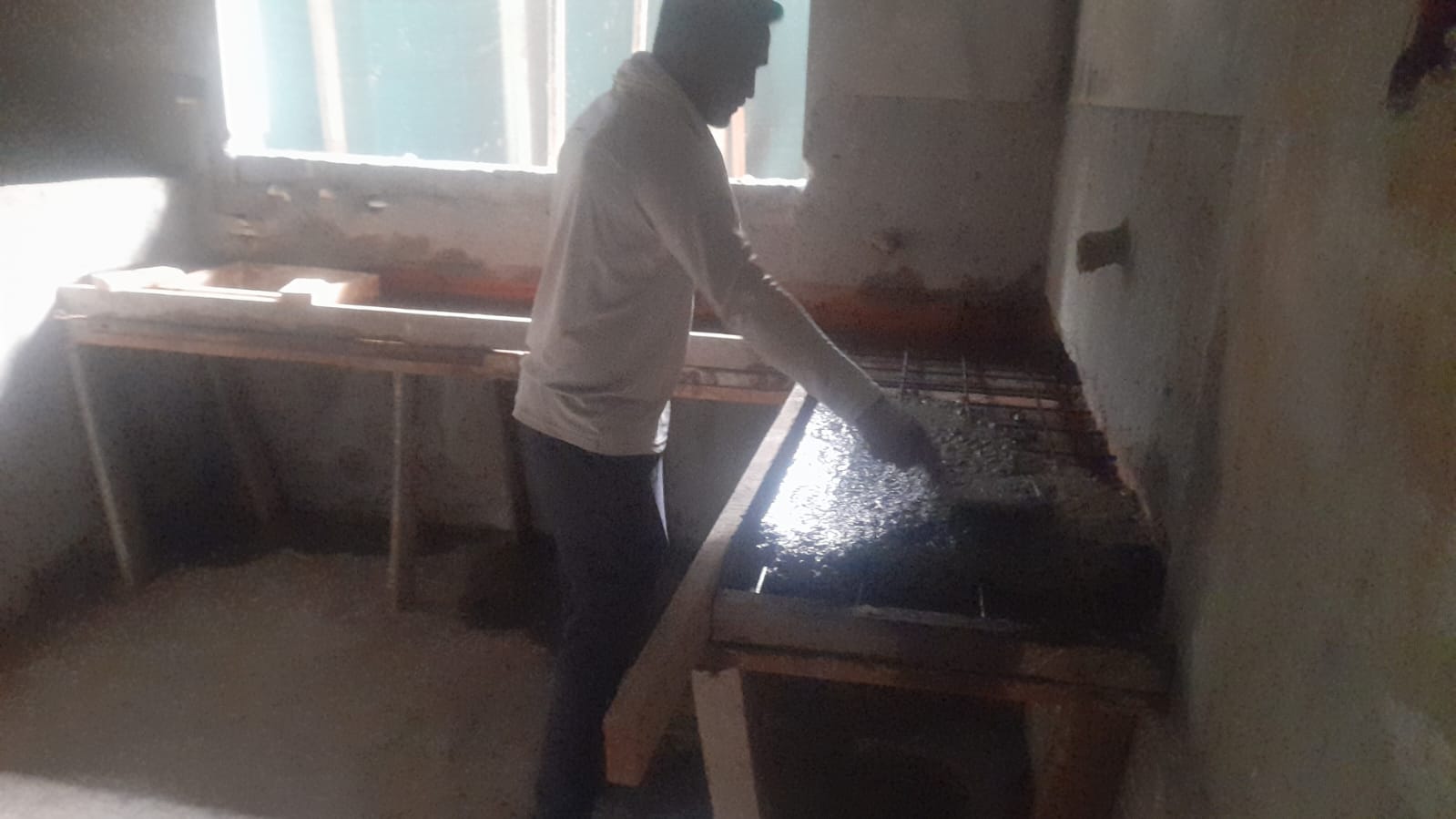

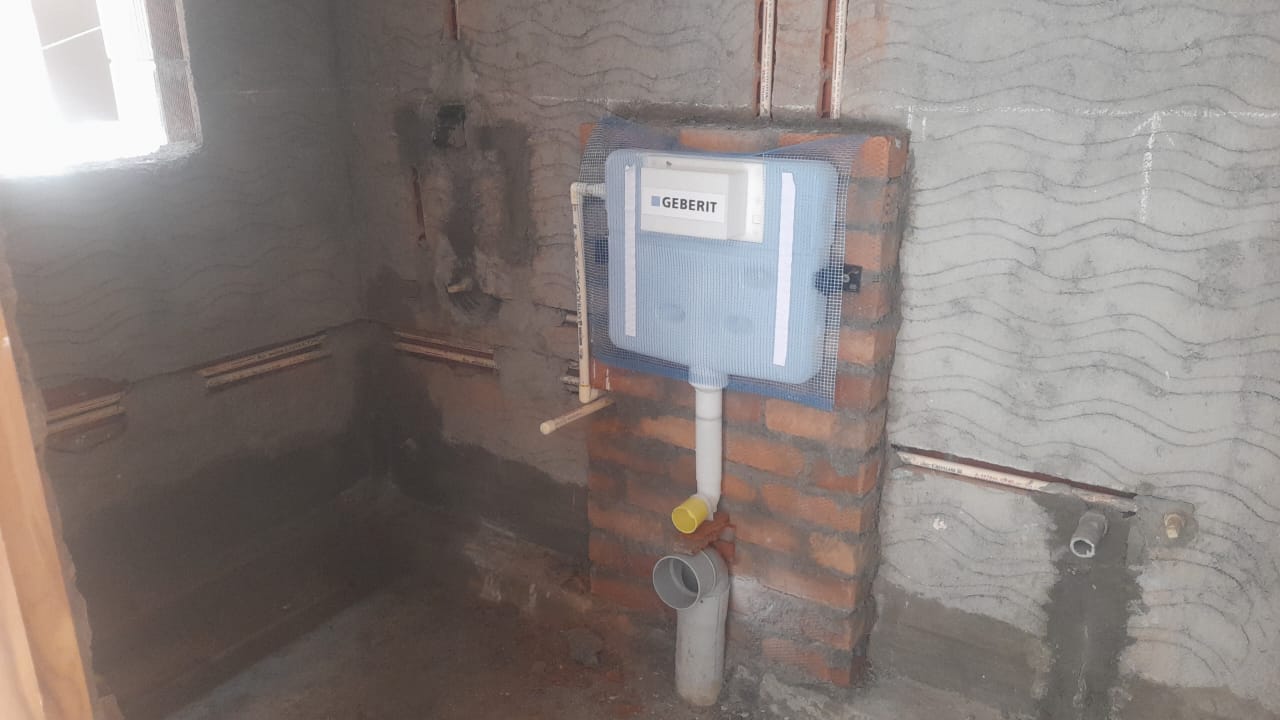

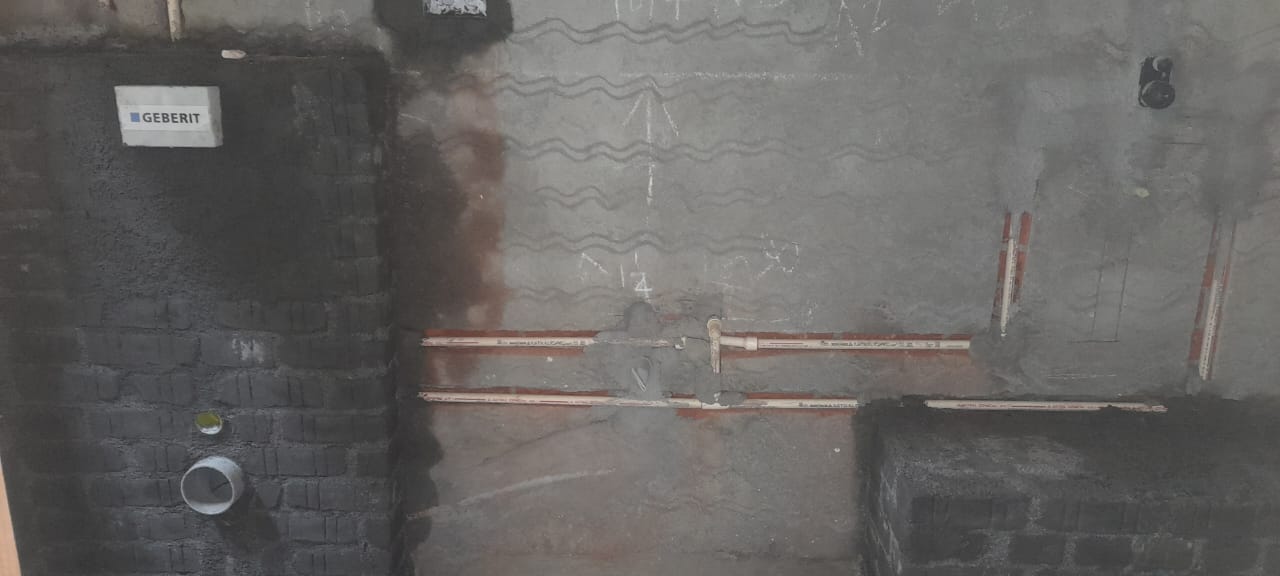

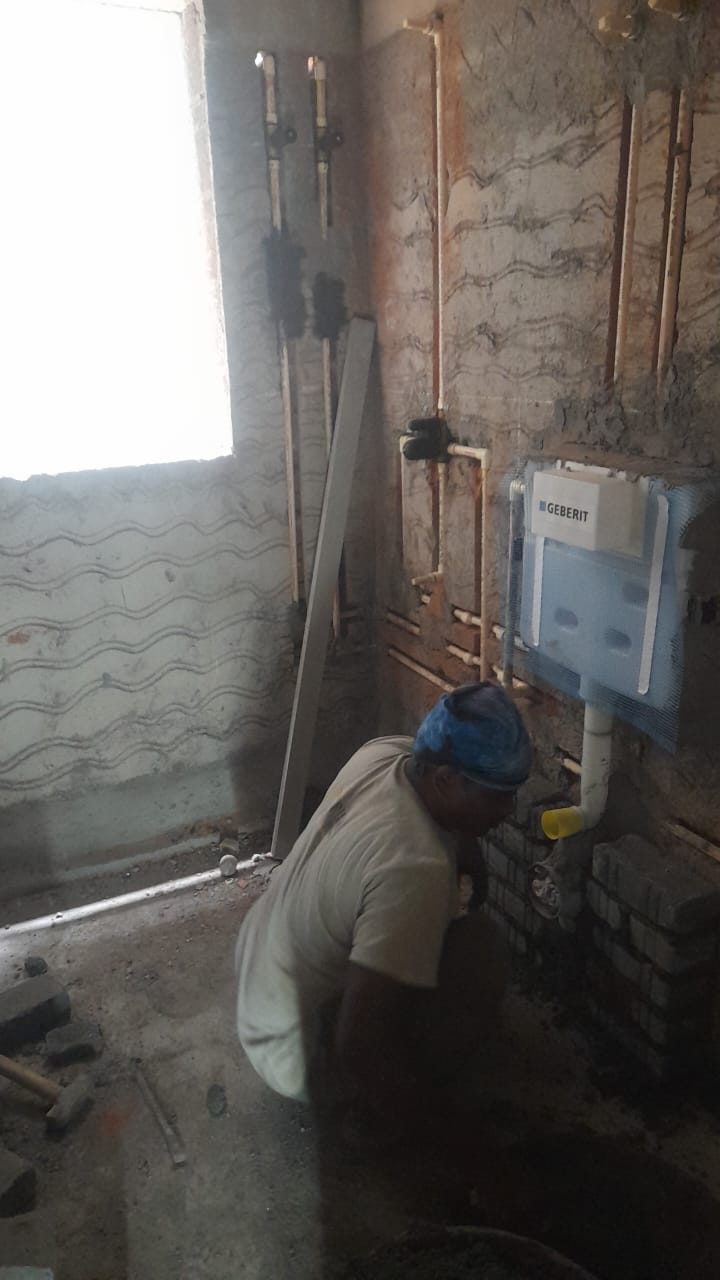

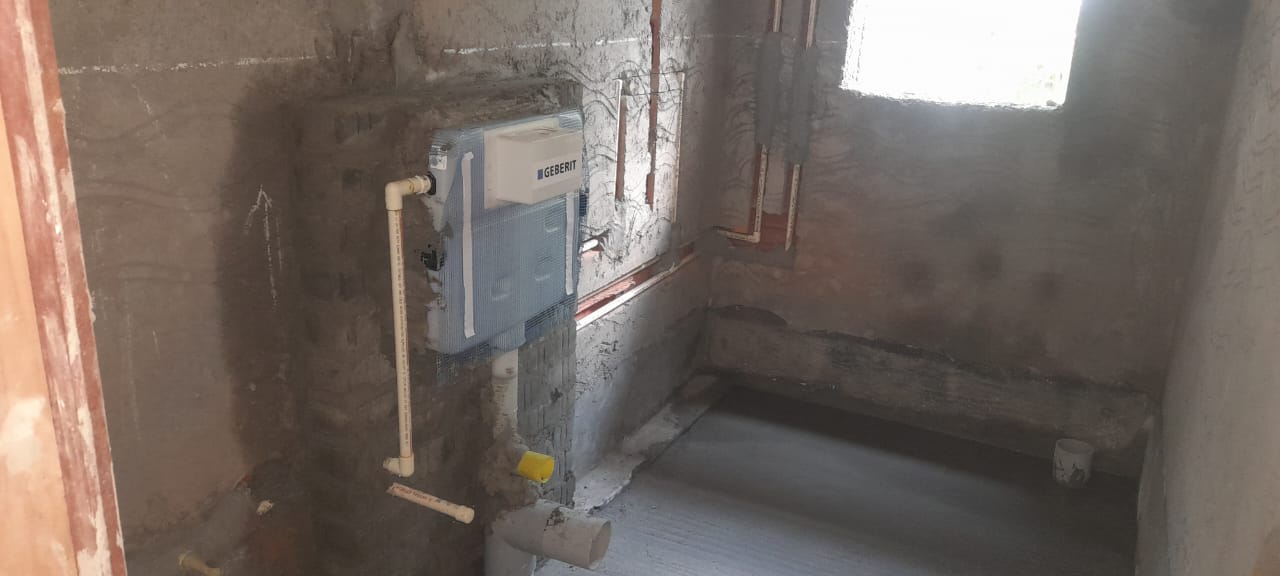

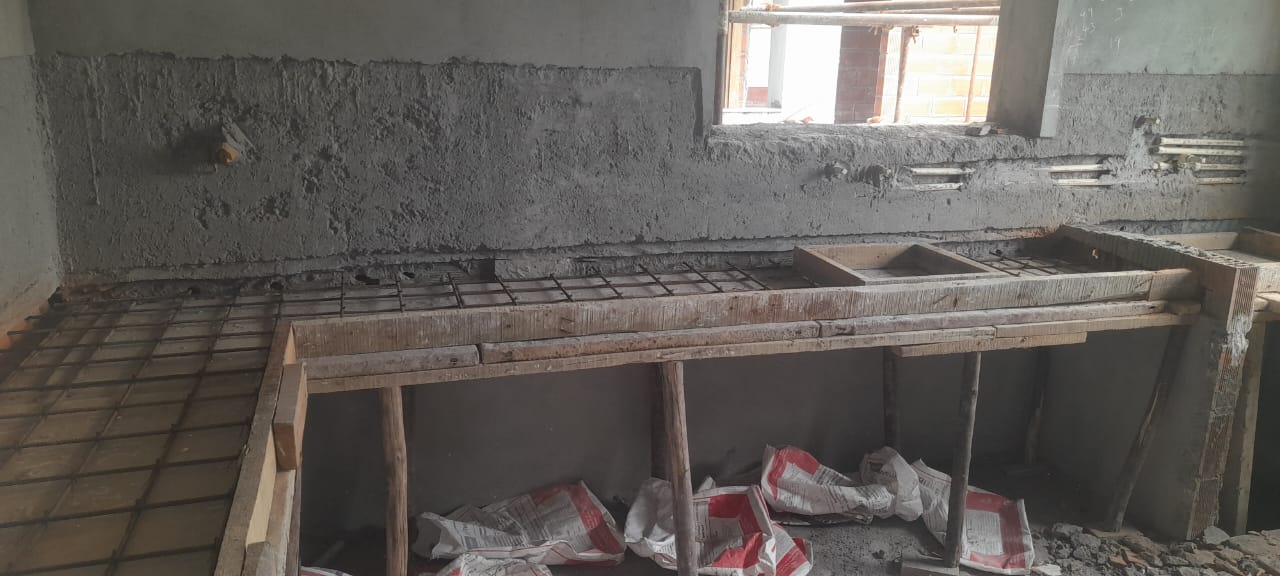

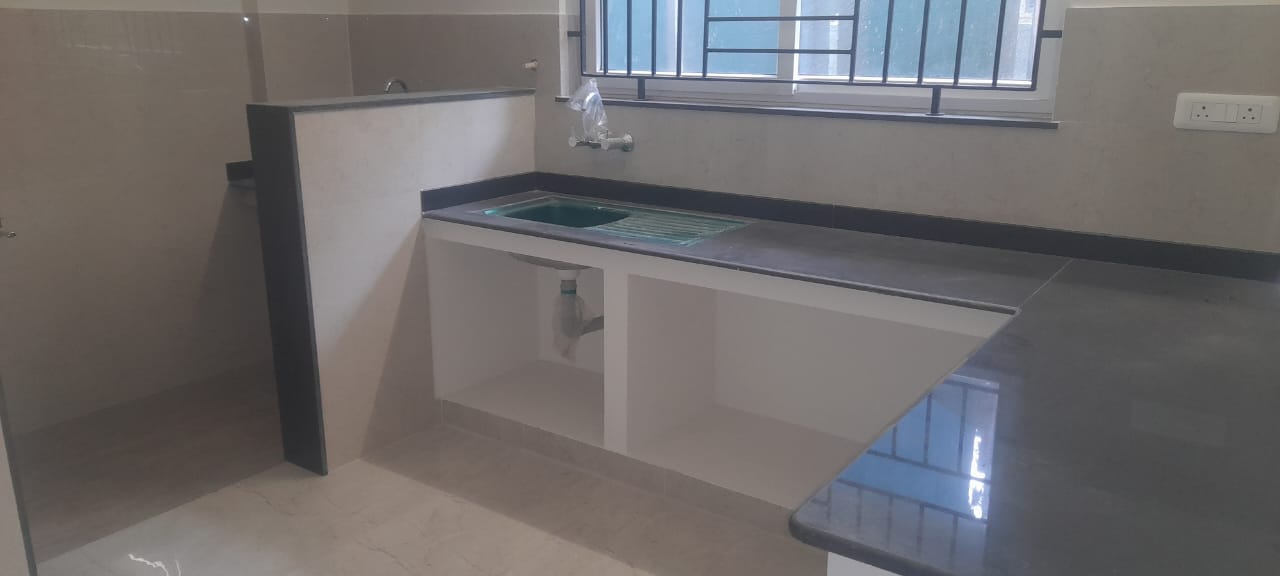

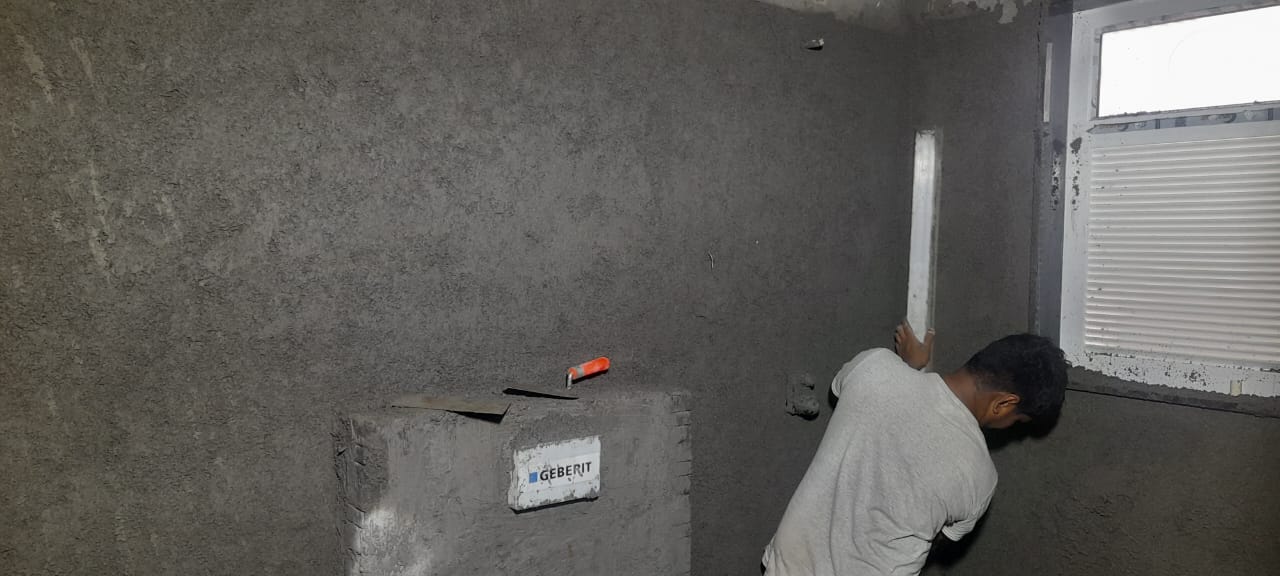

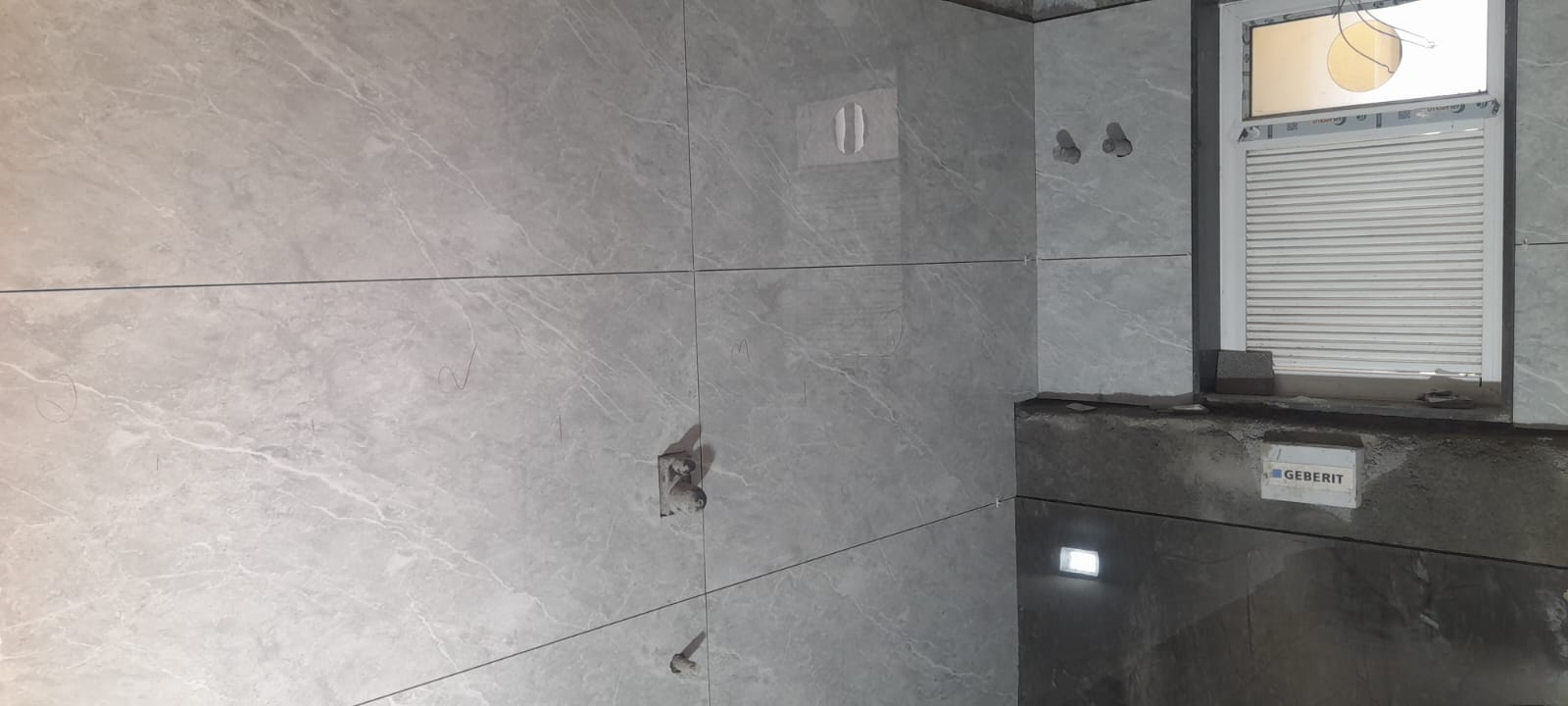

  • Toilet plumbing work is in progress. (5th floor)

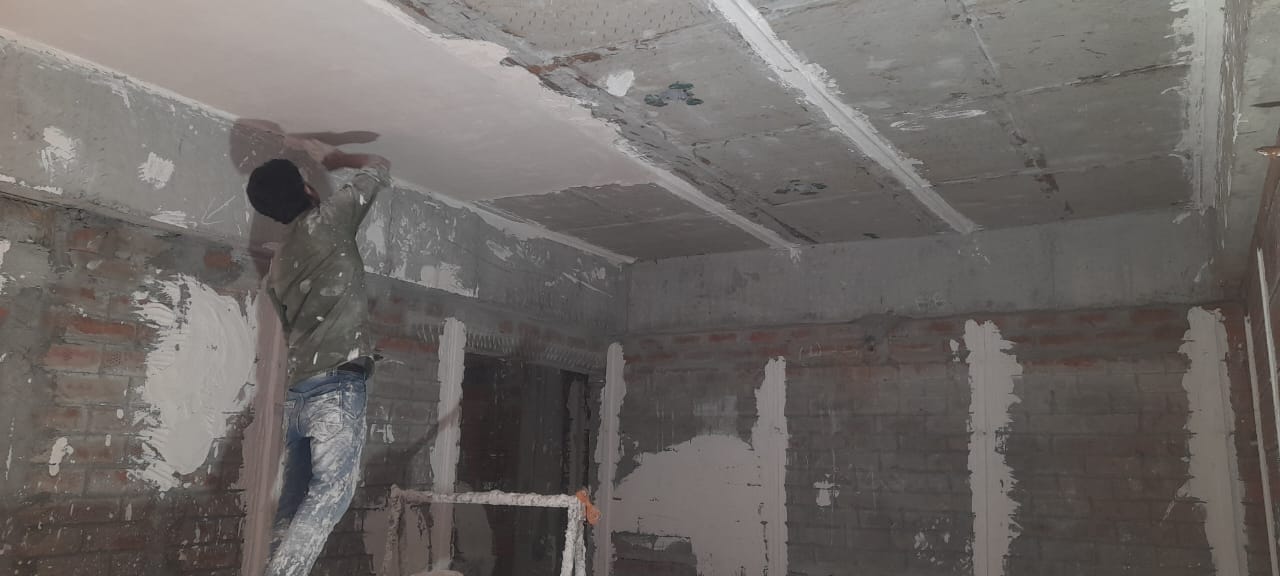

  • 5th floor inner plastering work is in progress.(80% completed)

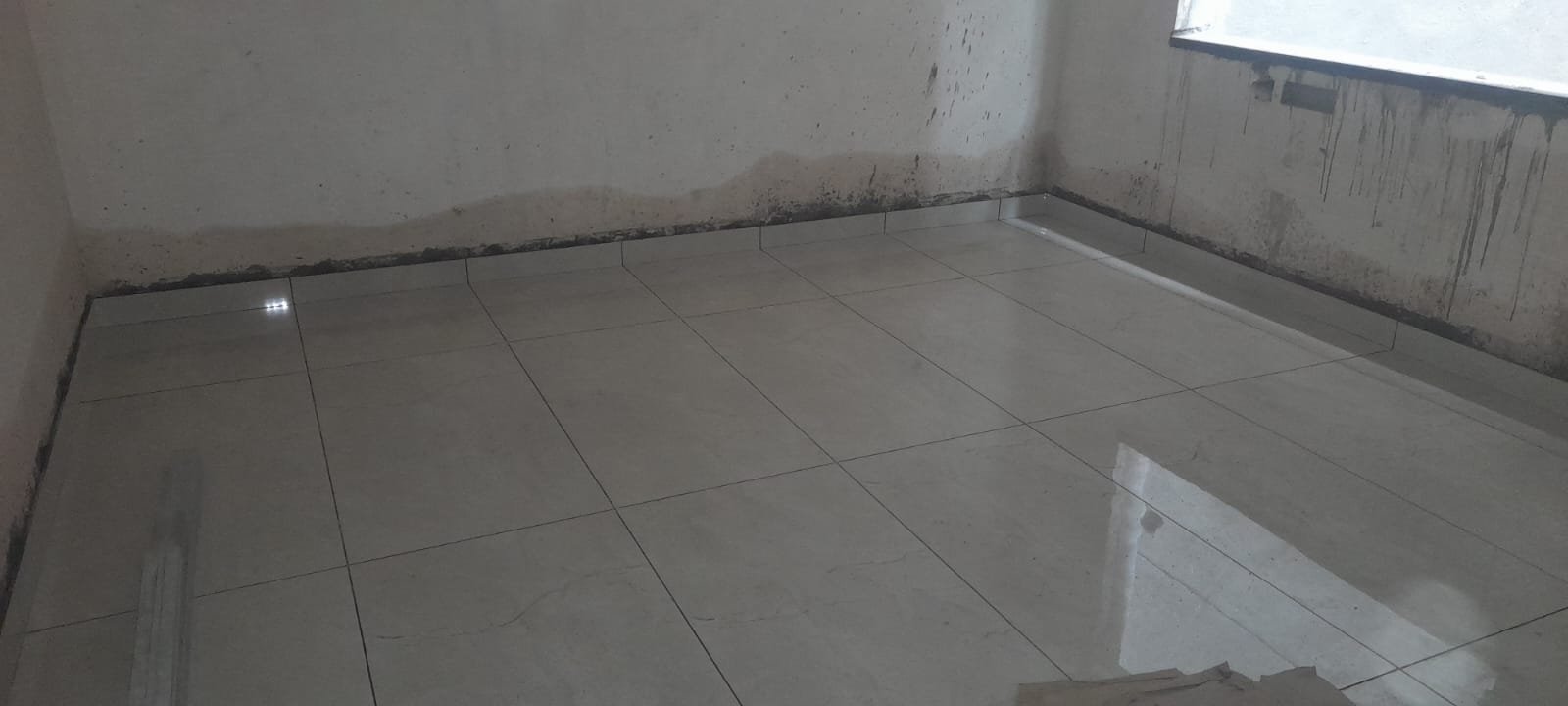

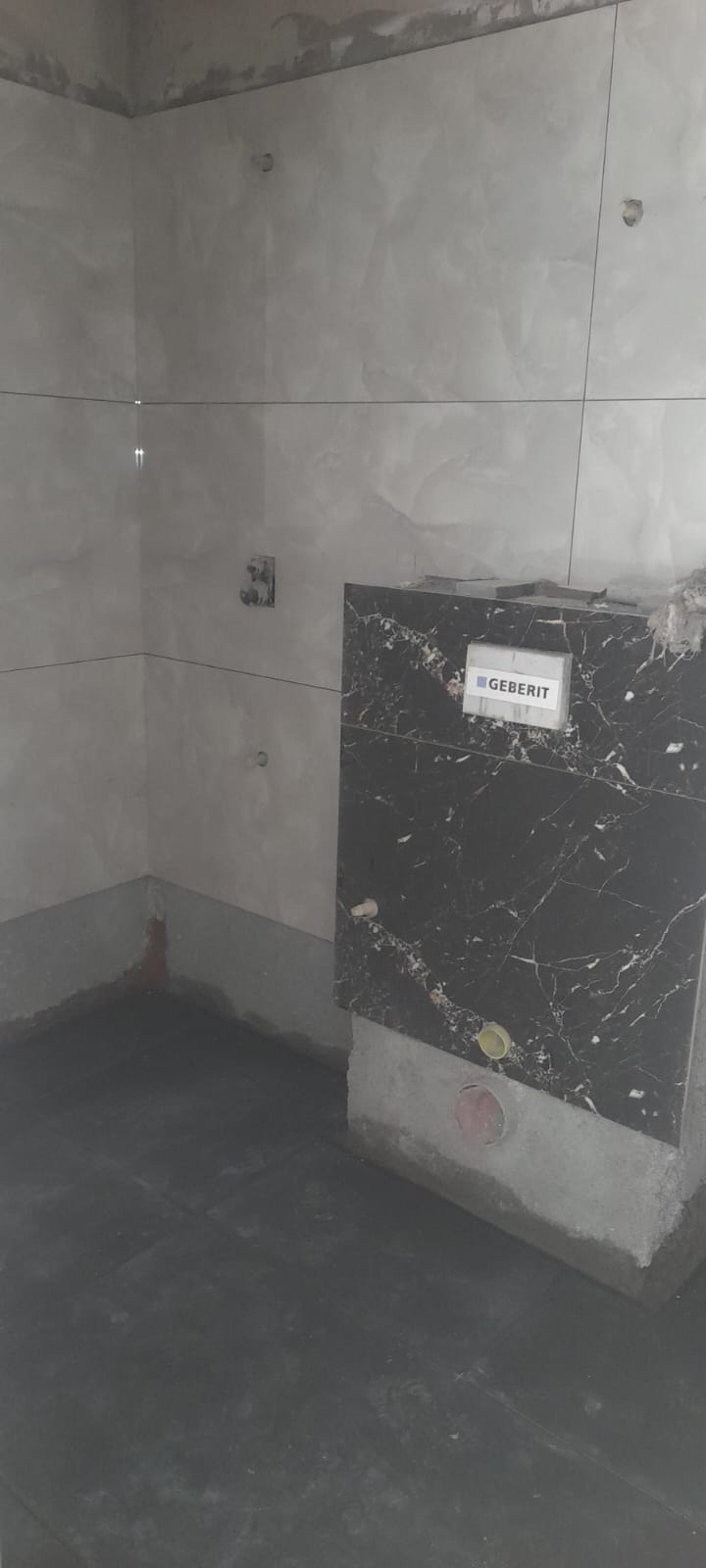

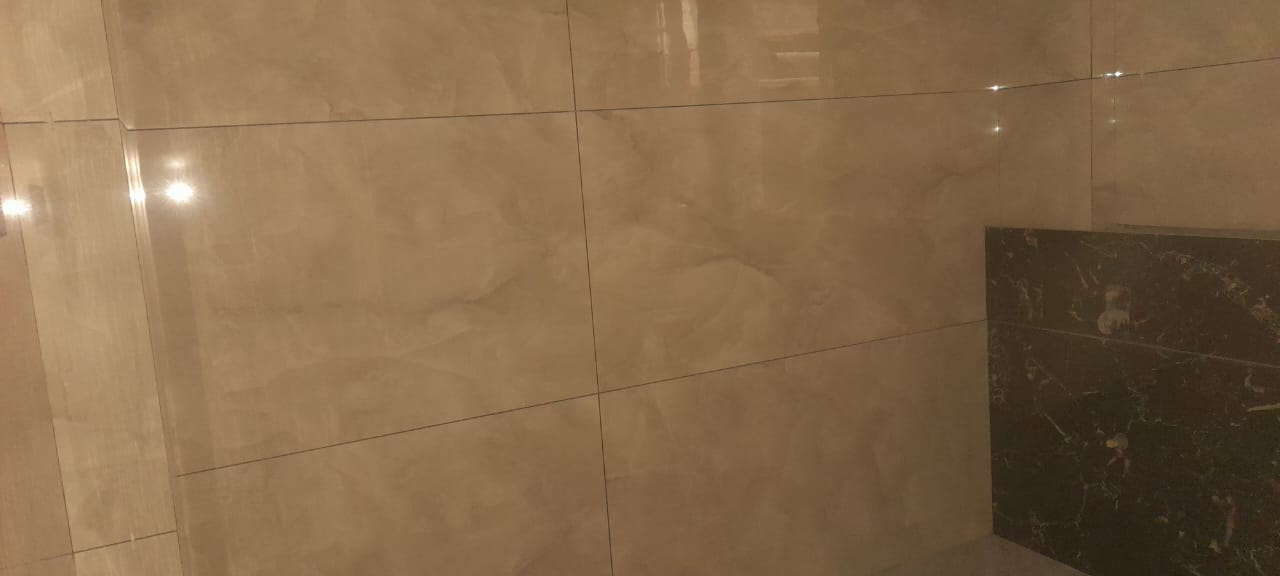

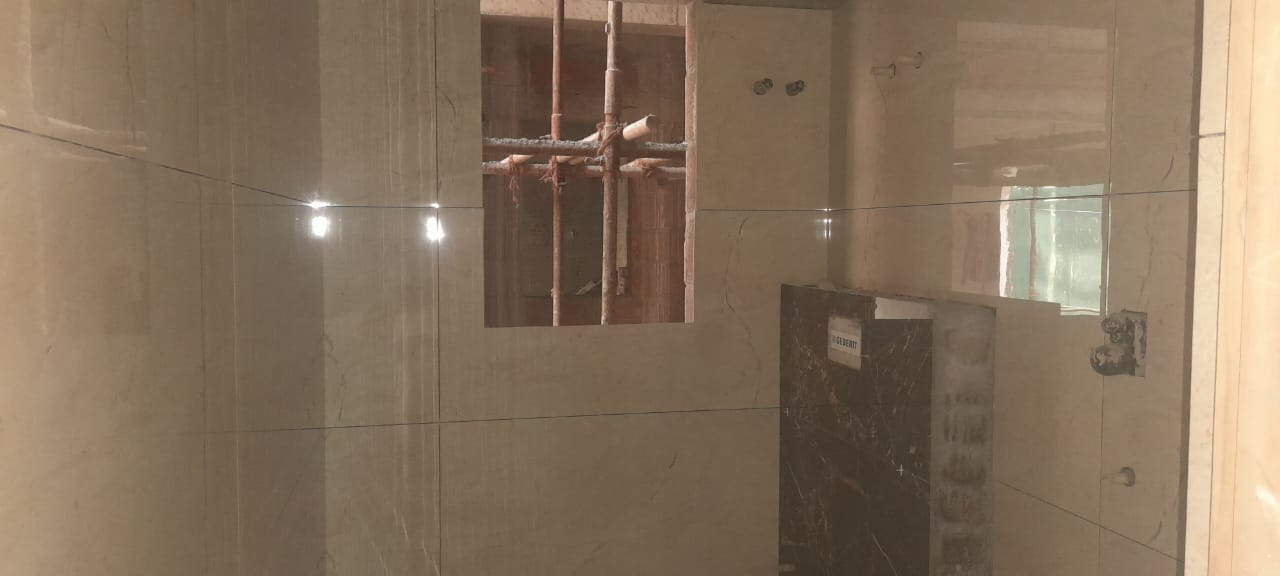

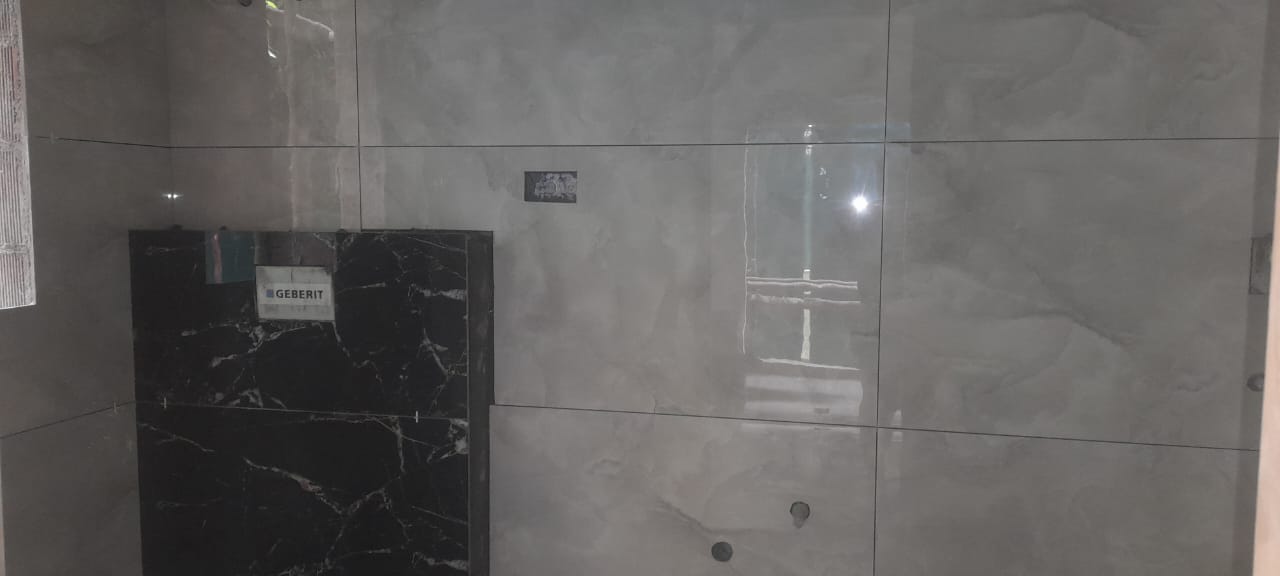

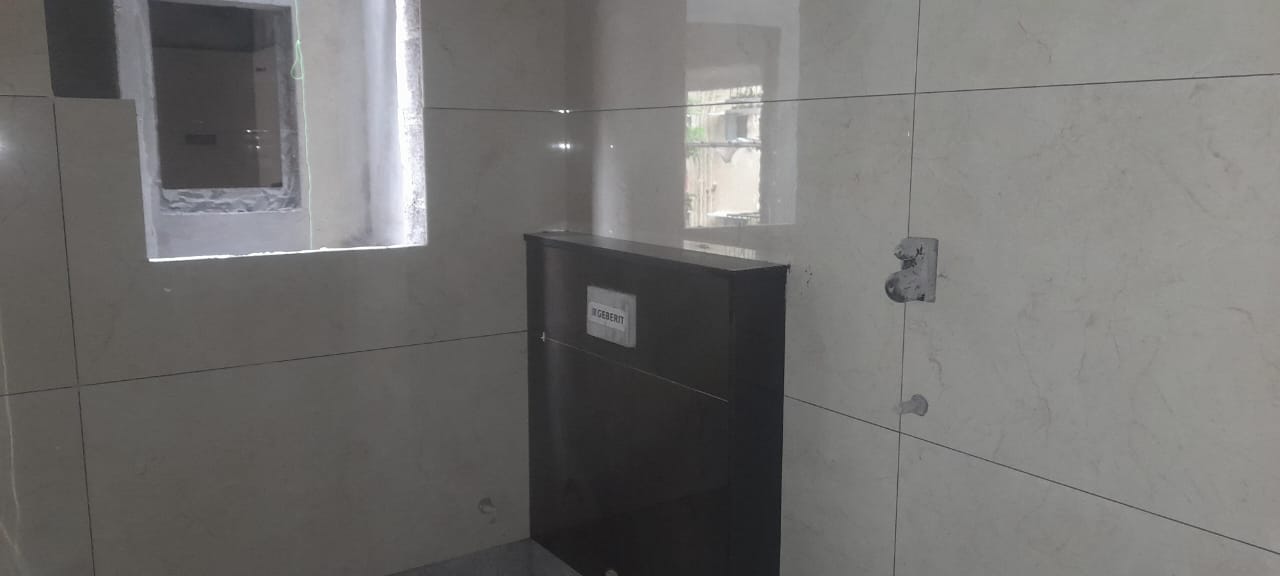

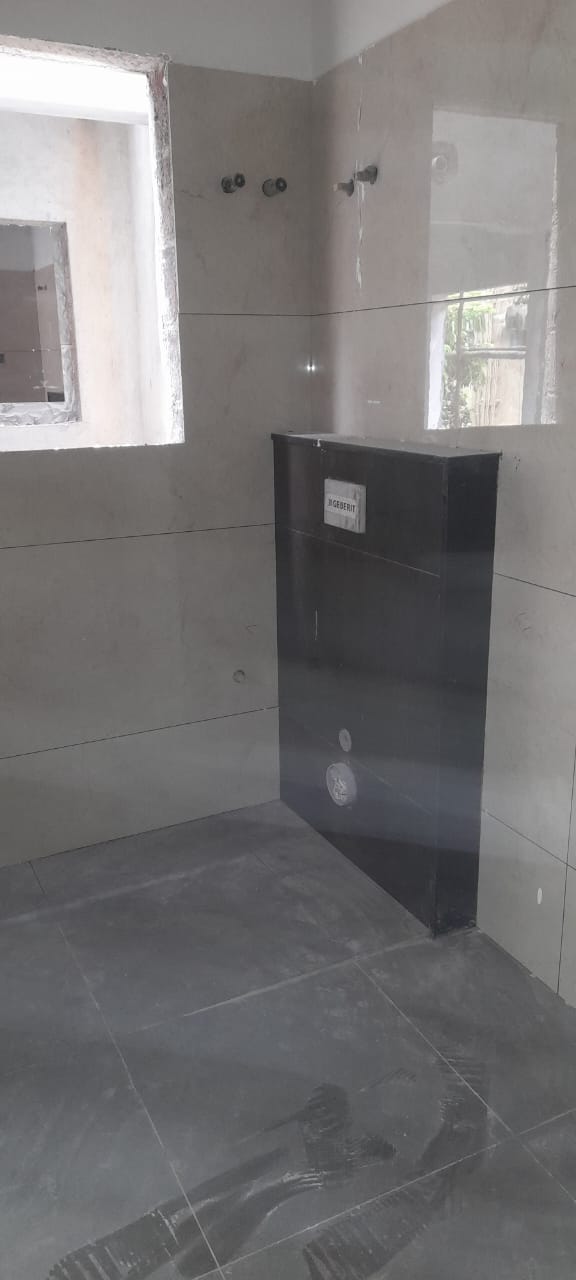

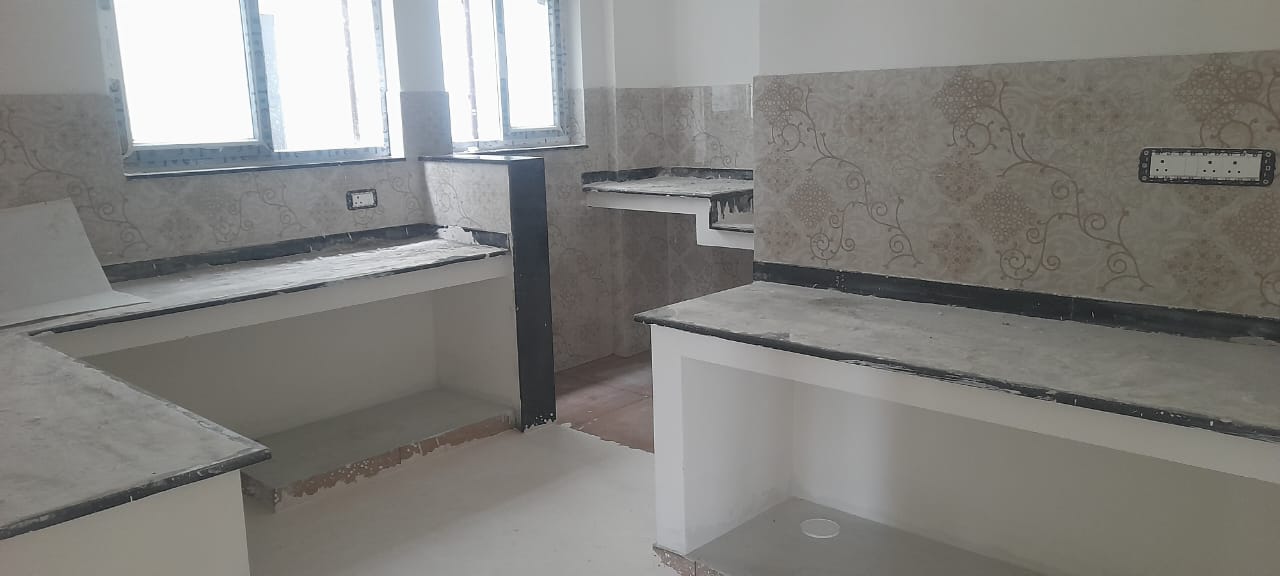

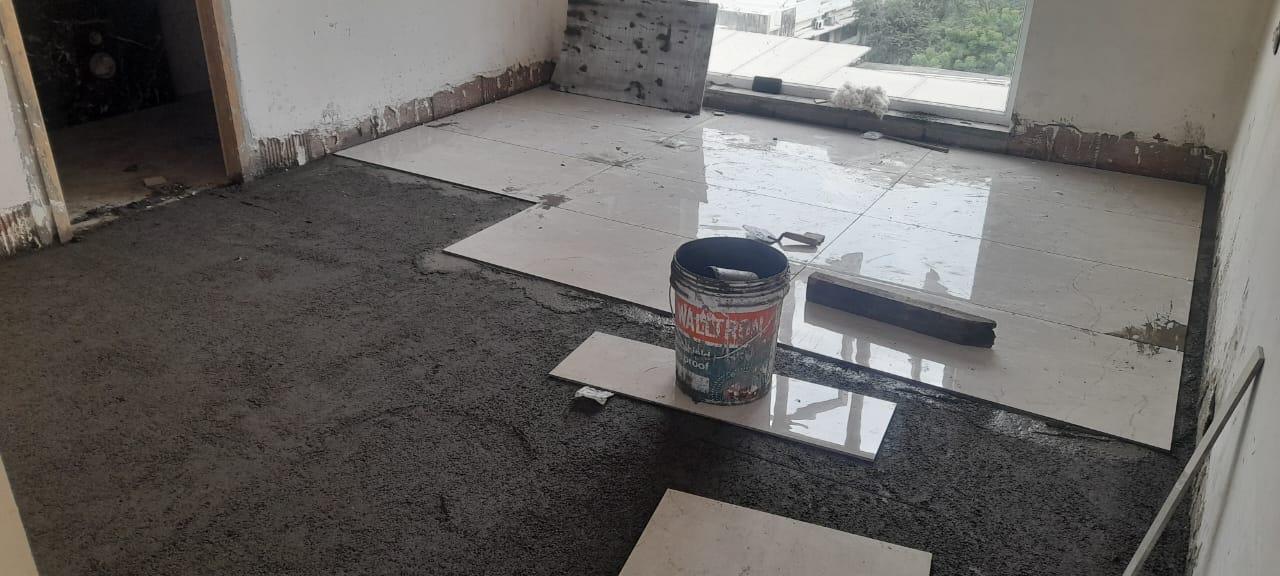

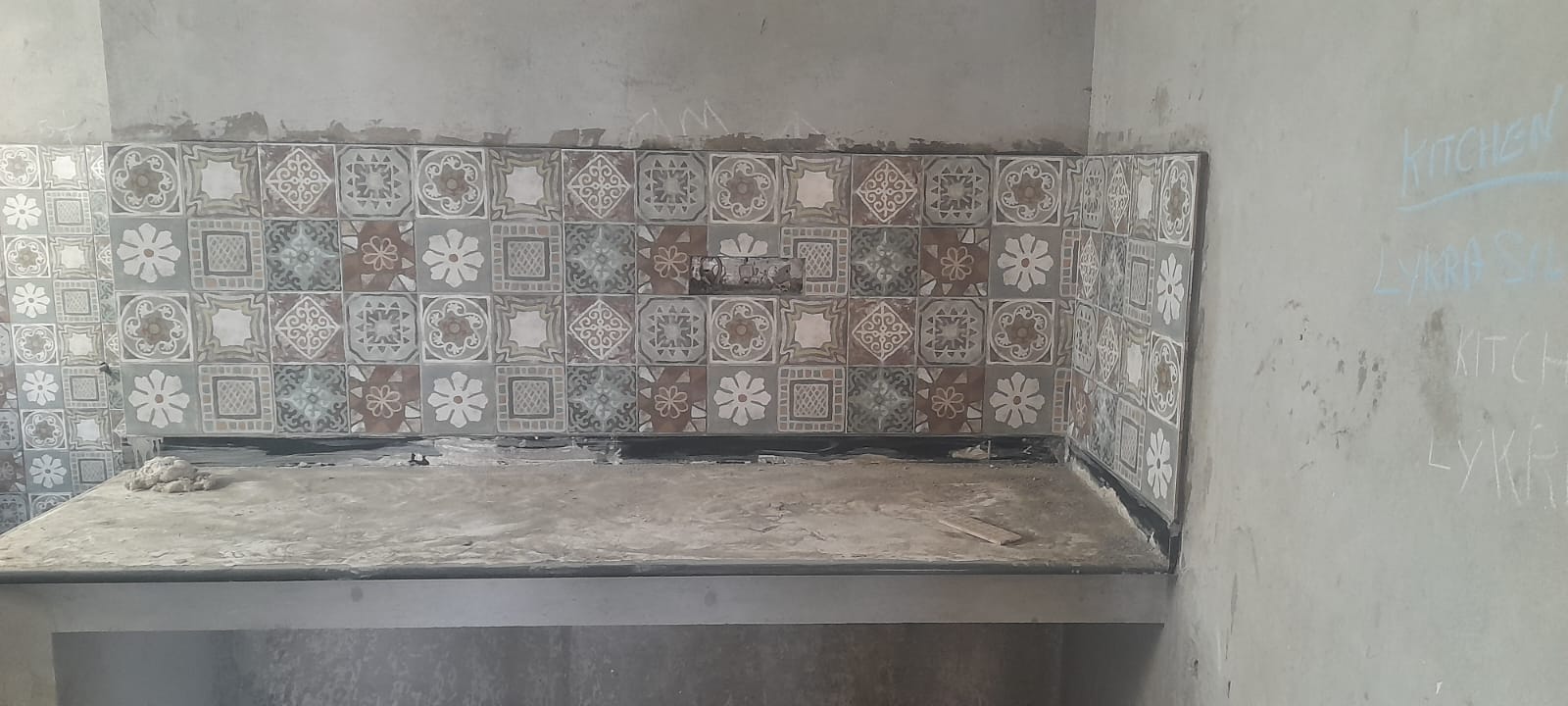

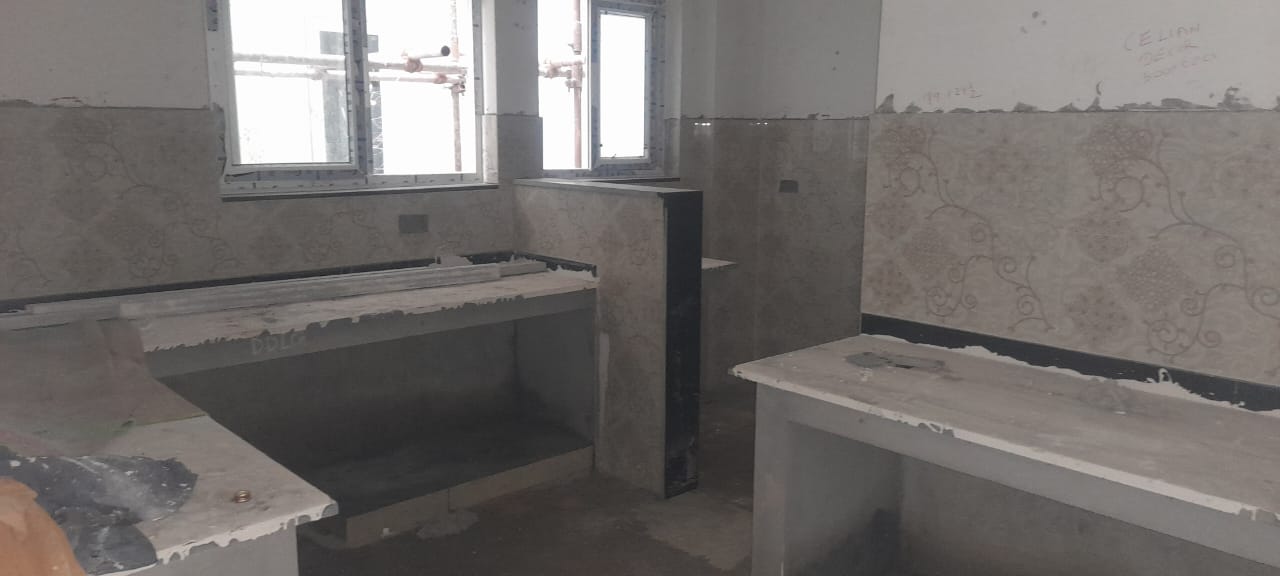

  • Toilet wall tile laying work is completed. (All floor)

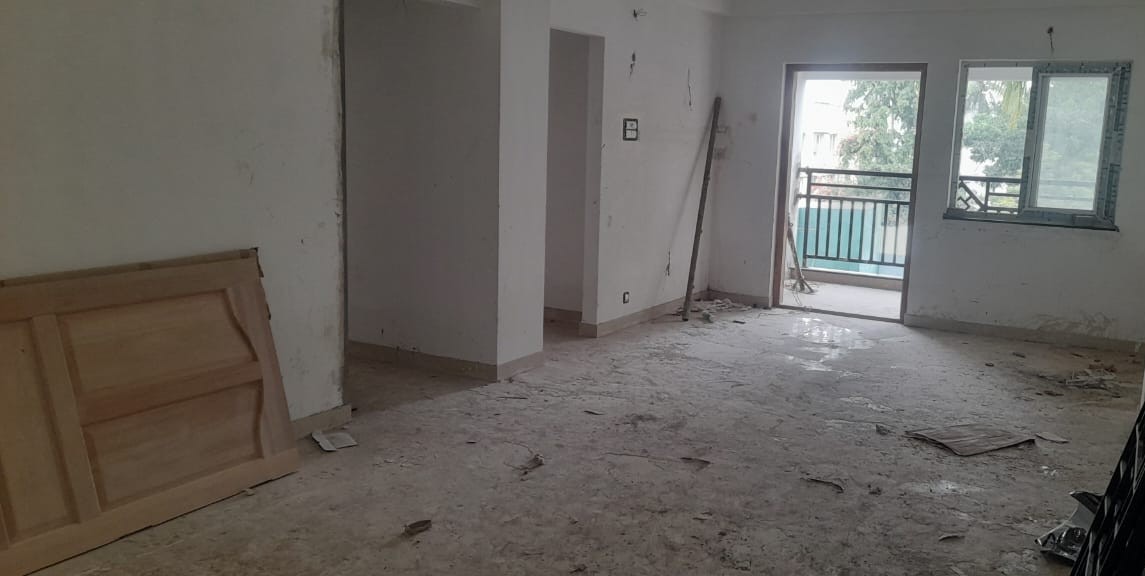

  • General floor work is in progress (15/25 flat completed)
  • Terrace weathering course work is in progress. (60% completed)
  • External 1st coat painting work is completed.
  • Toilet plumbing work is completed.(All floor)

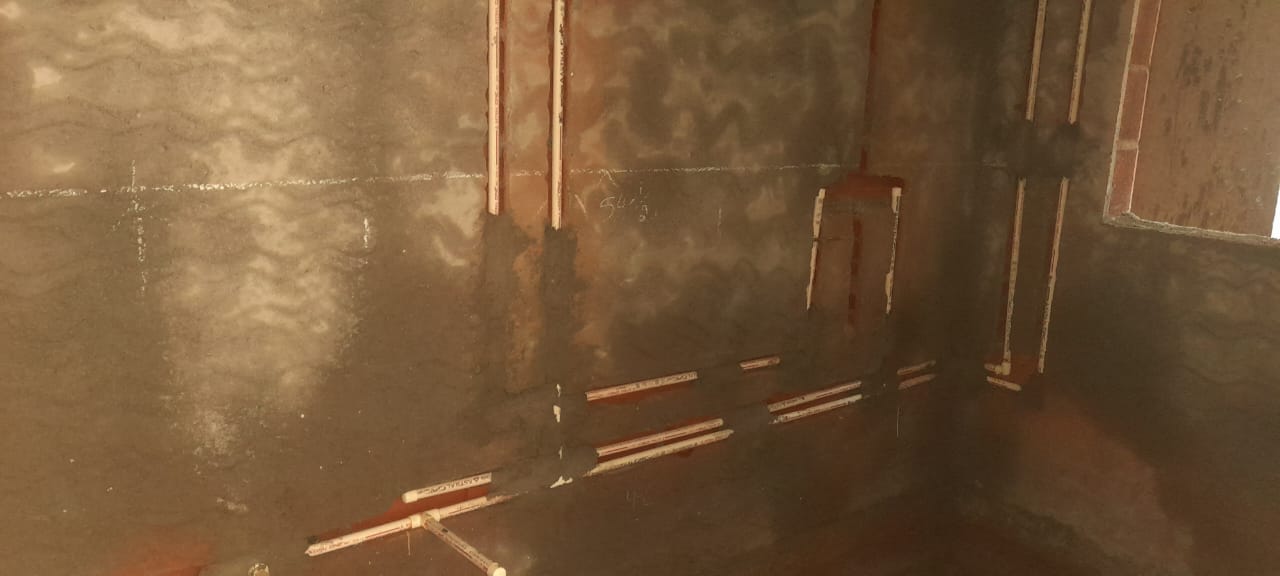

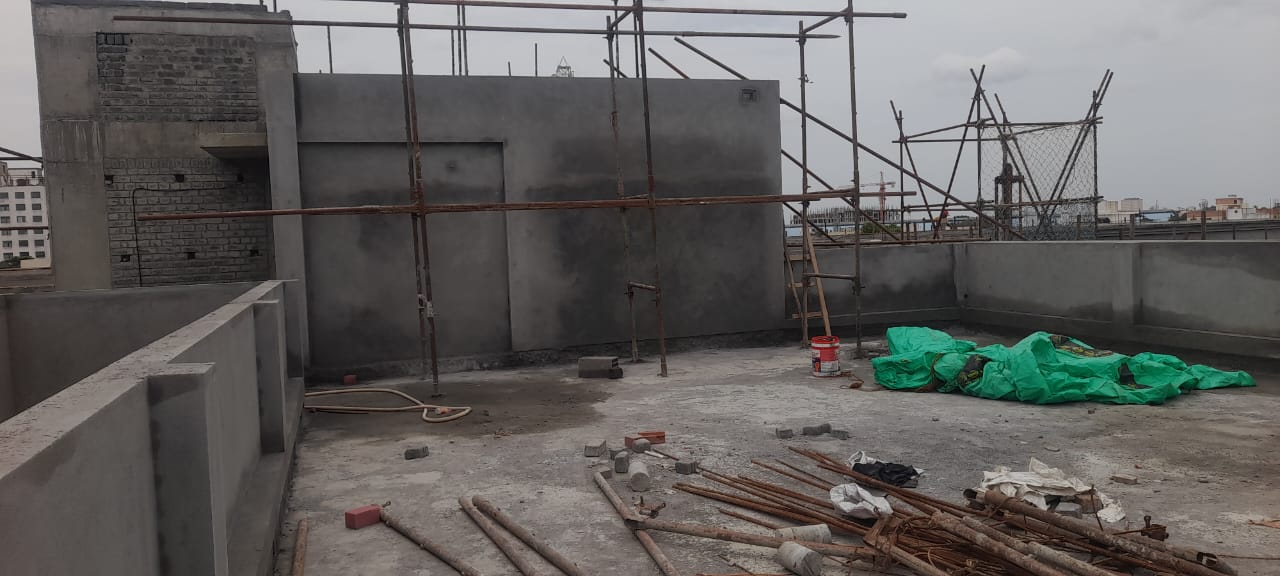

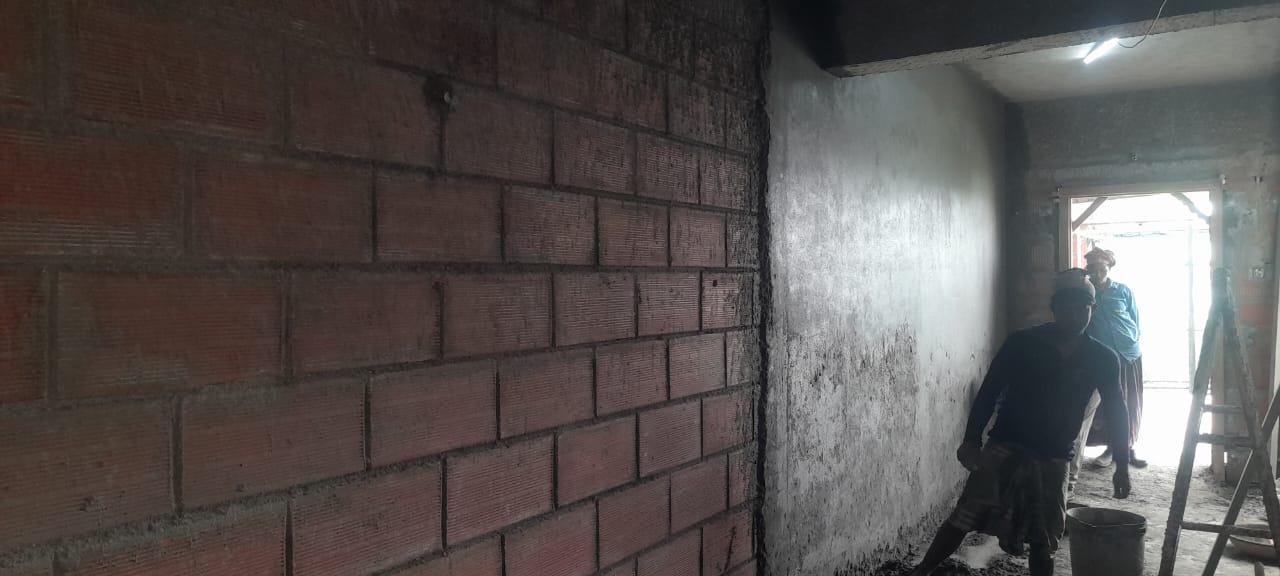

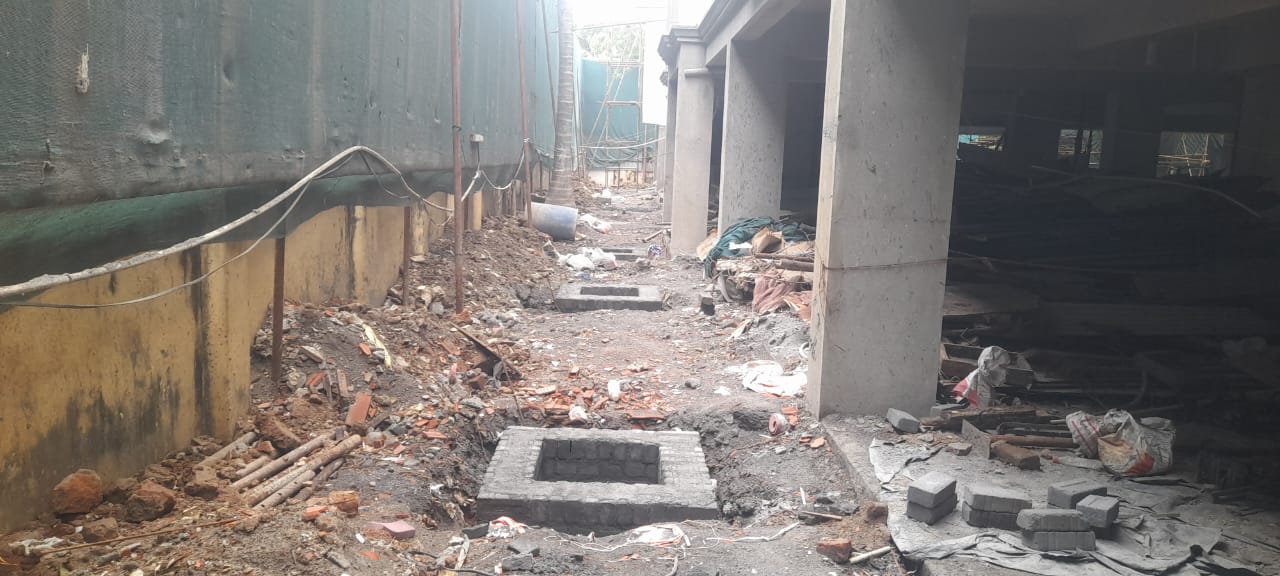

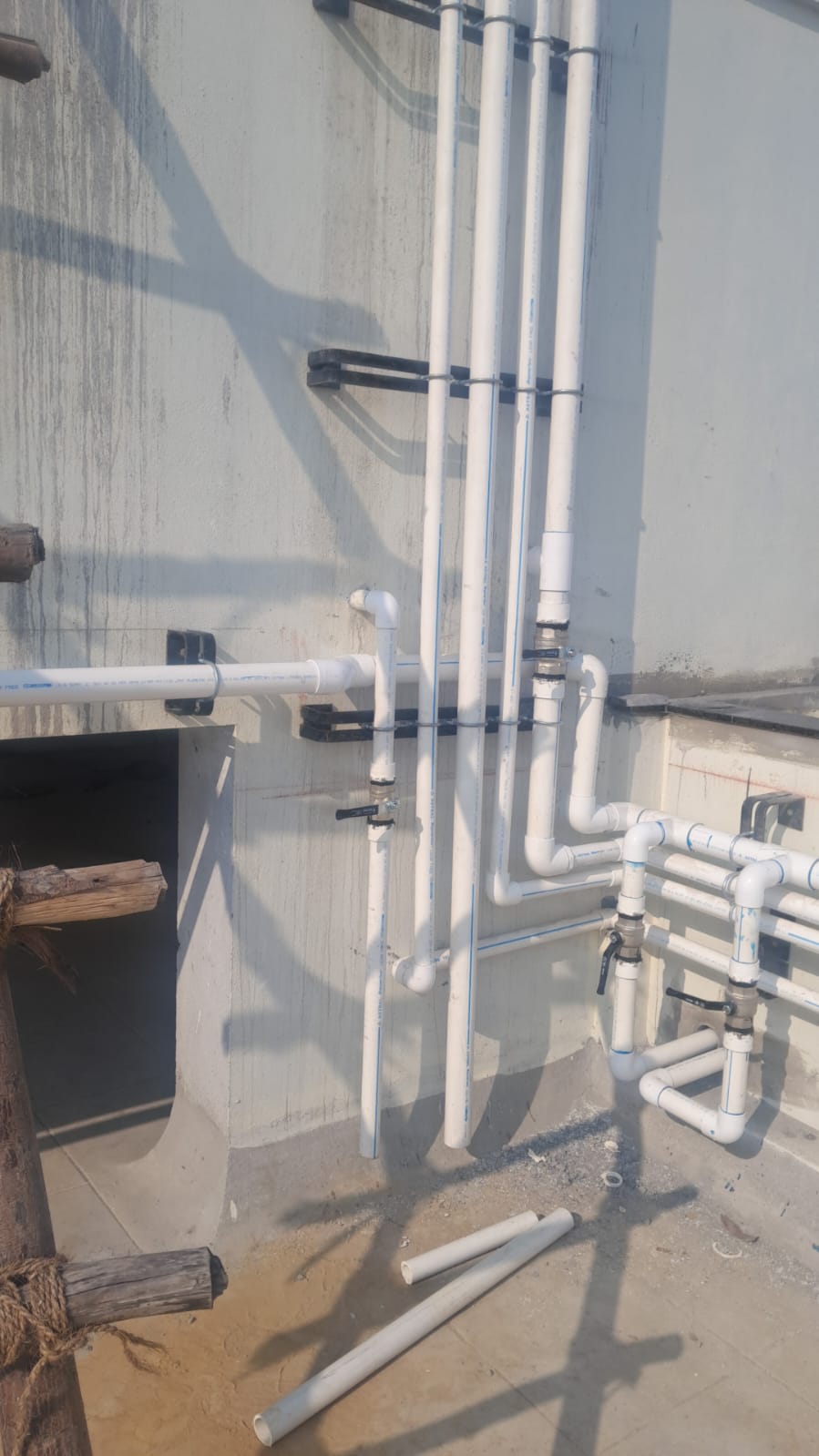

  • Duct plumbing work is in progress.
  • 5th floor inner plastering work is in progress.(80% completed)
  • Toilet wall tile laying work is completed. (All floor)
  • General floor work is in progress (15/25 flat completed)
  • Terrace weathering course work is in progress. (70% completed)

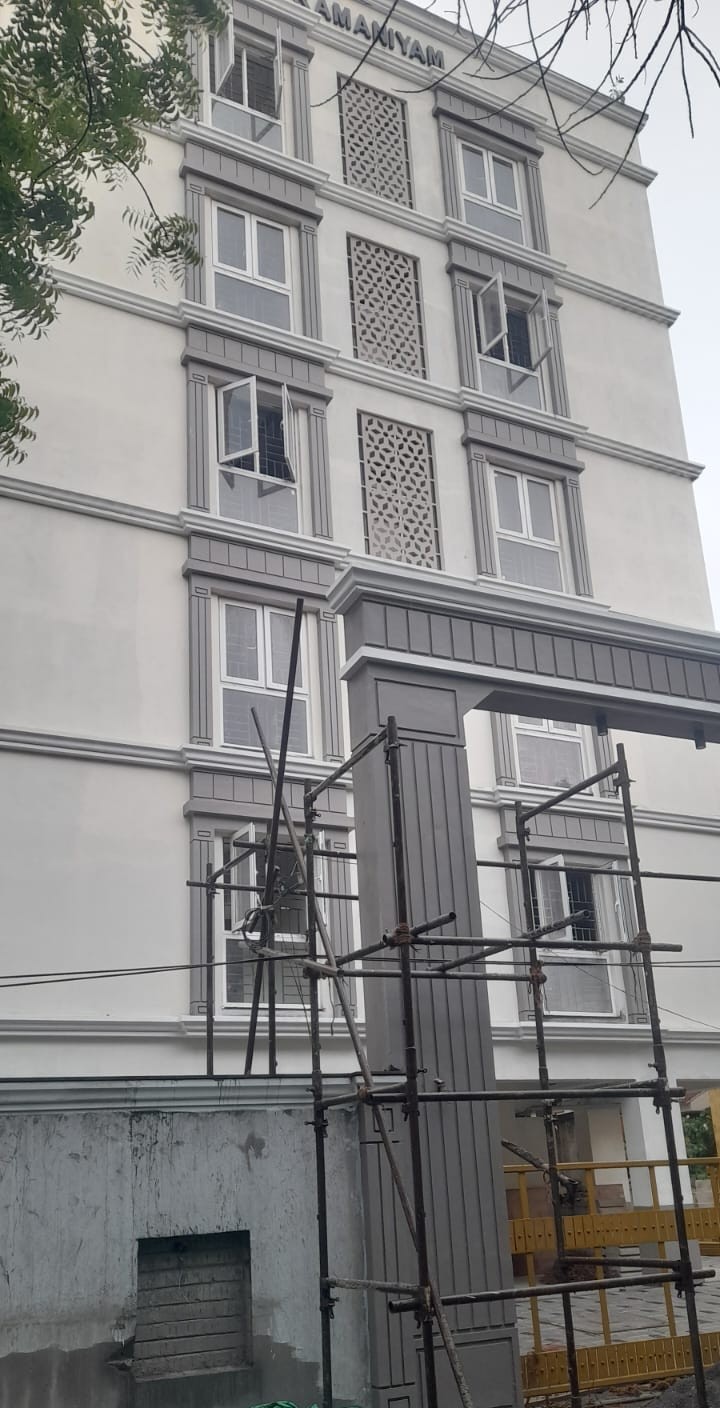

  • External 1st coat painting work is completed.
  • Toilet plumbing work is completed.(All floor)
  • Duct plumbing work is in progress.

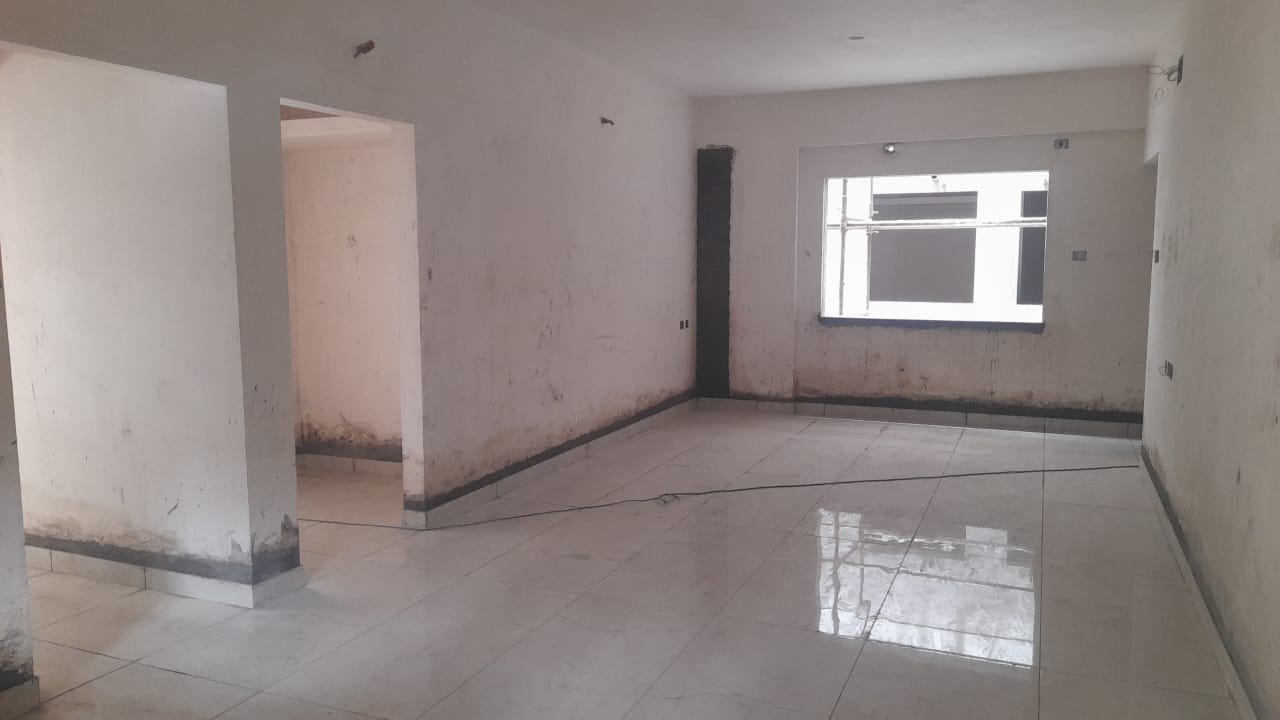

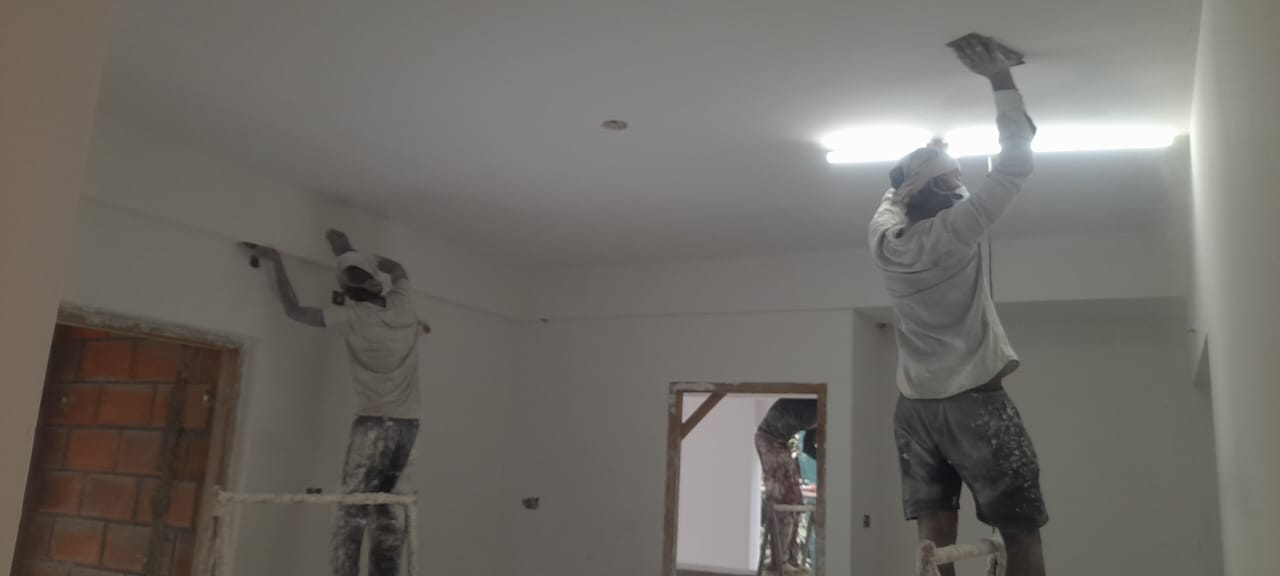

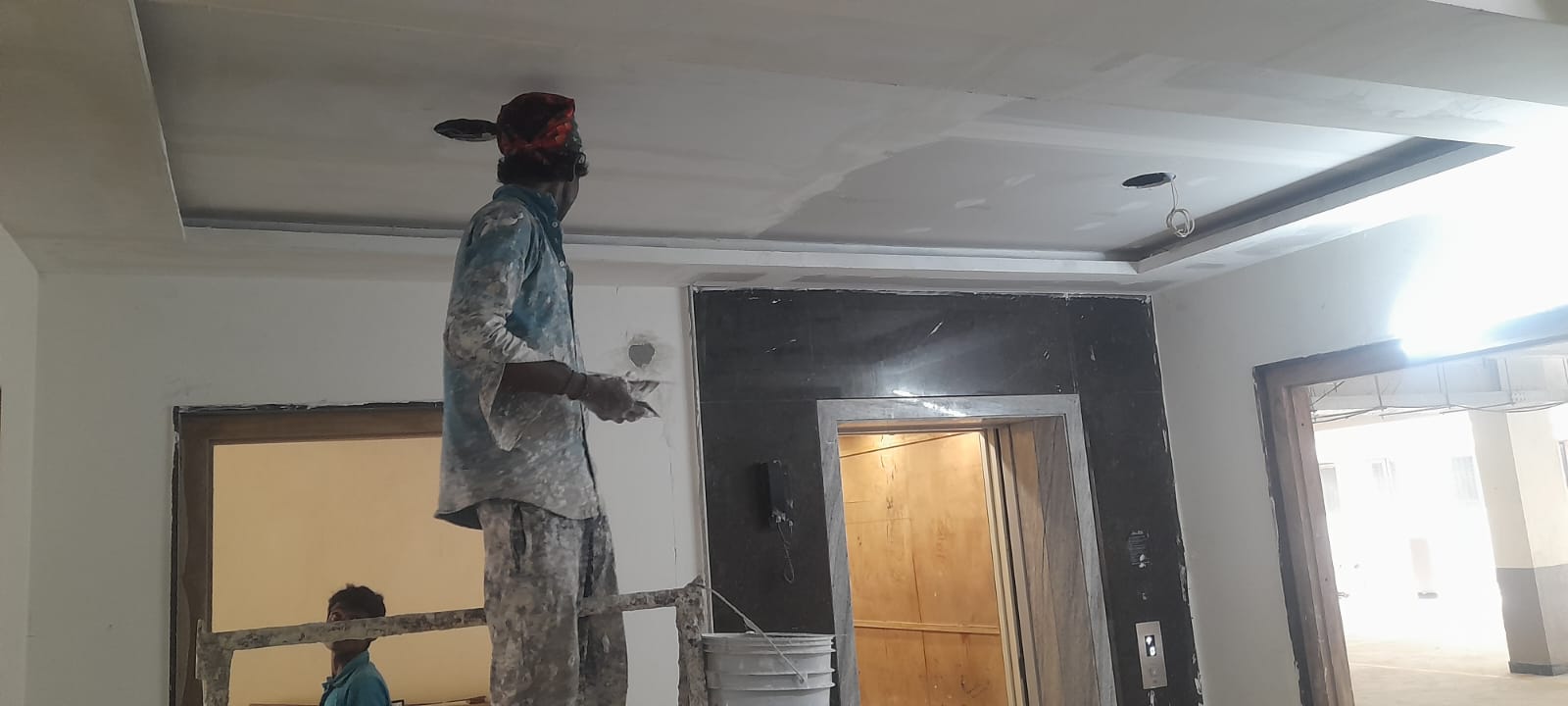

  • 5th floor inner plastering work is completed.
  • All floors toilet wall tile laying work is completed.

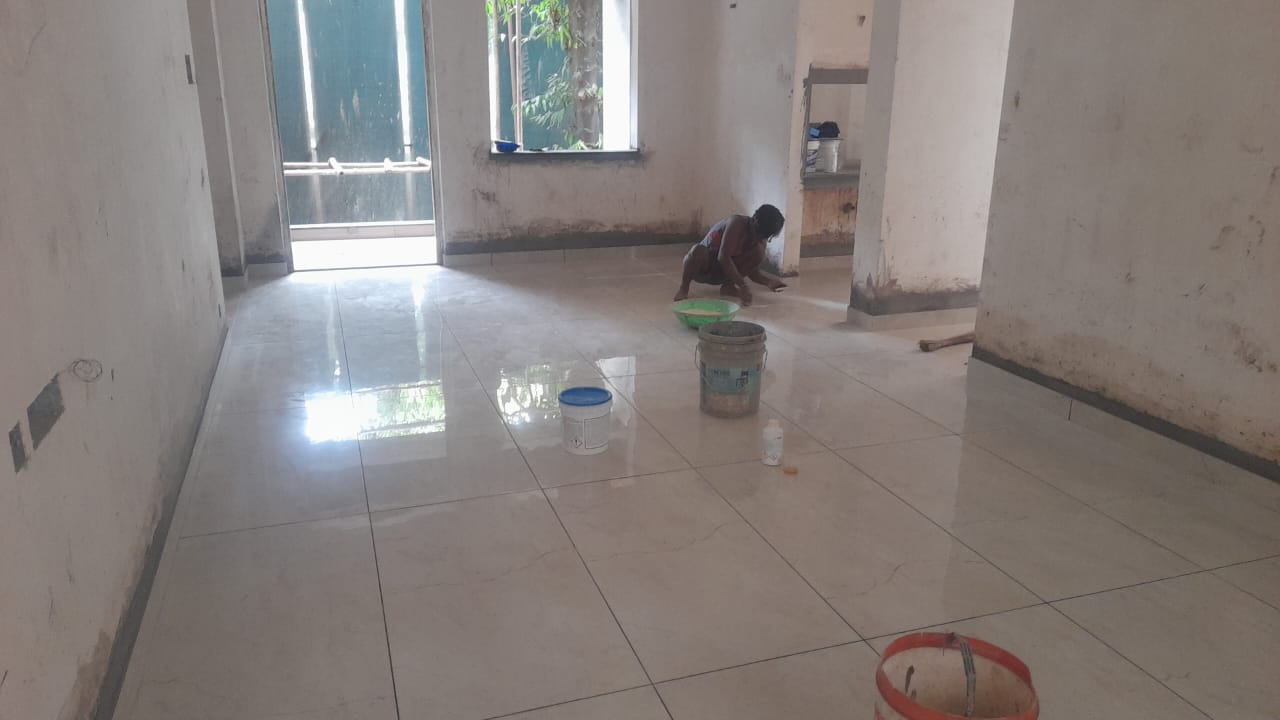

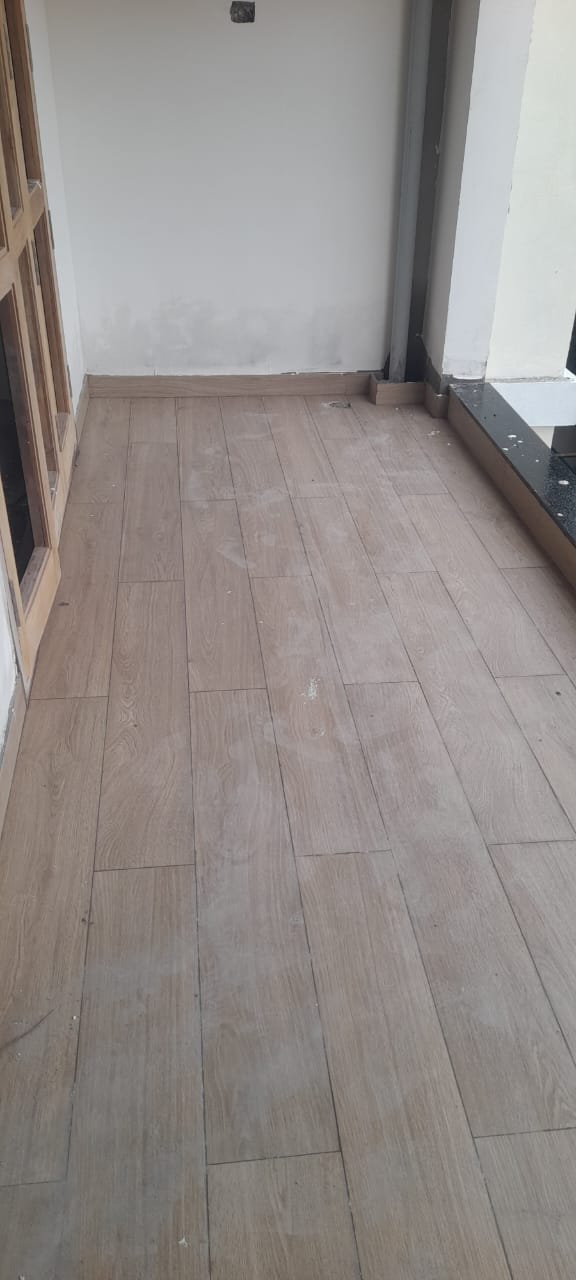

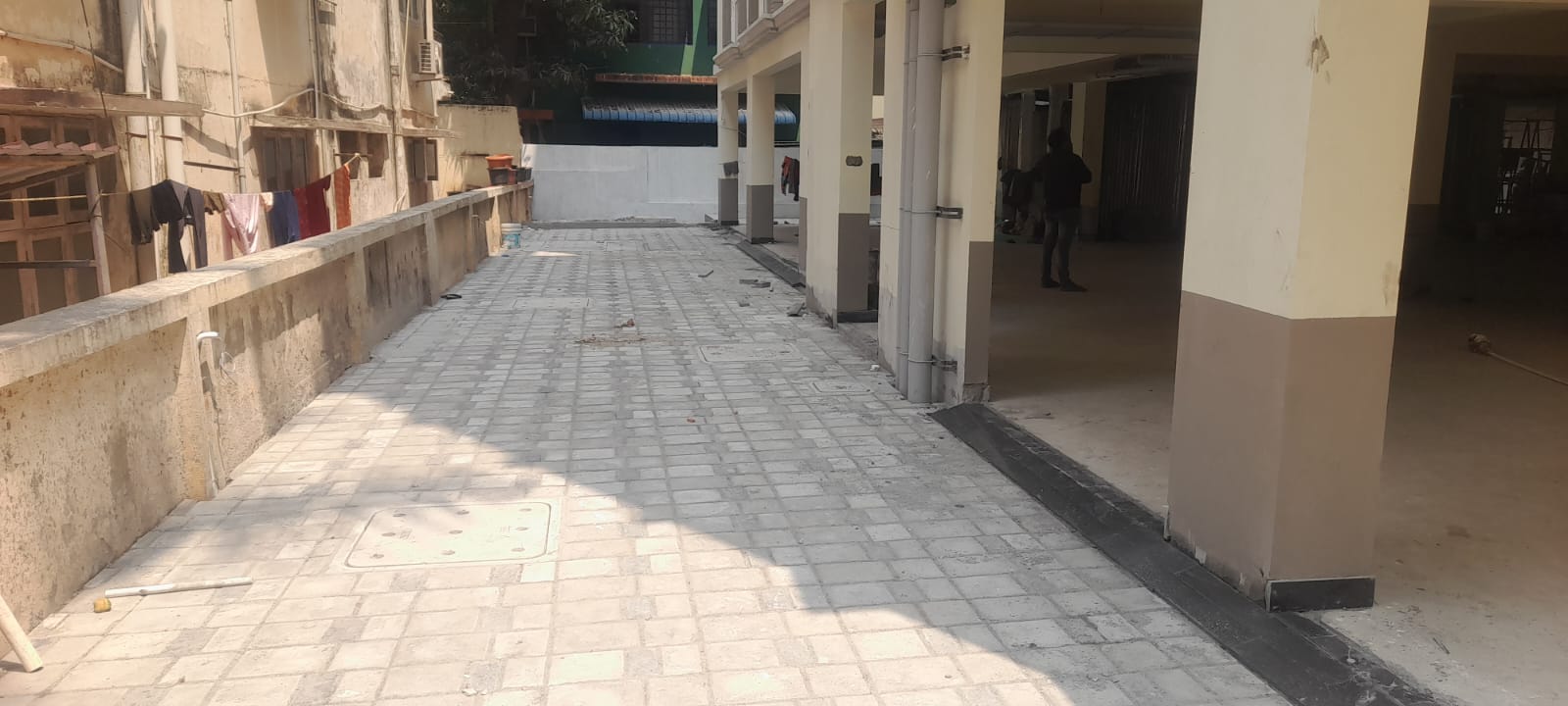

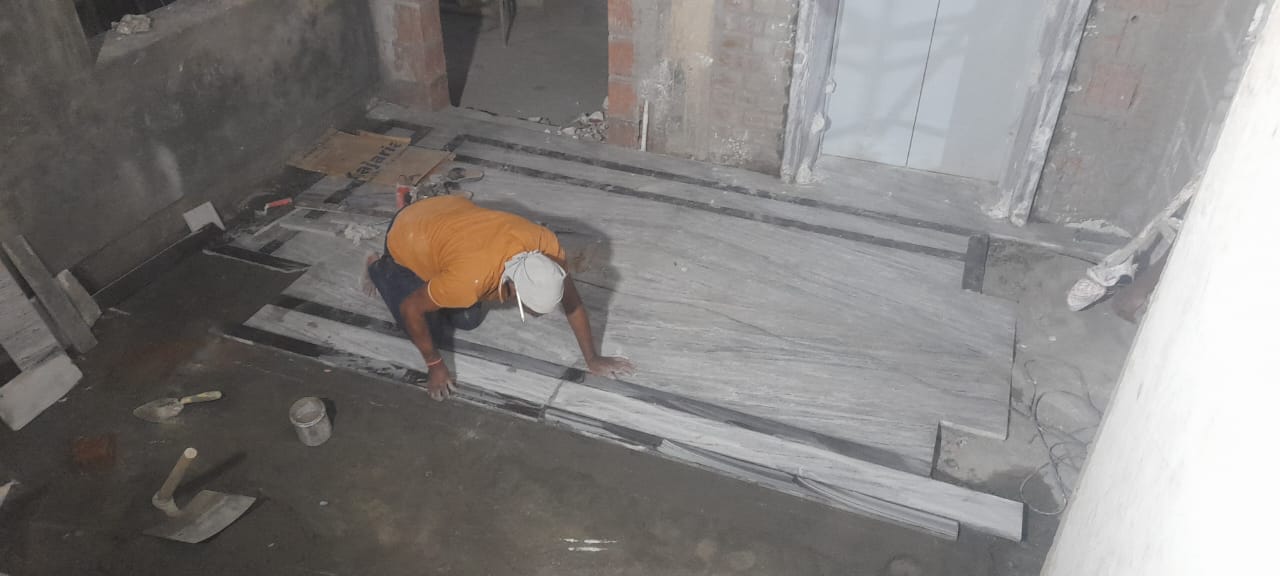

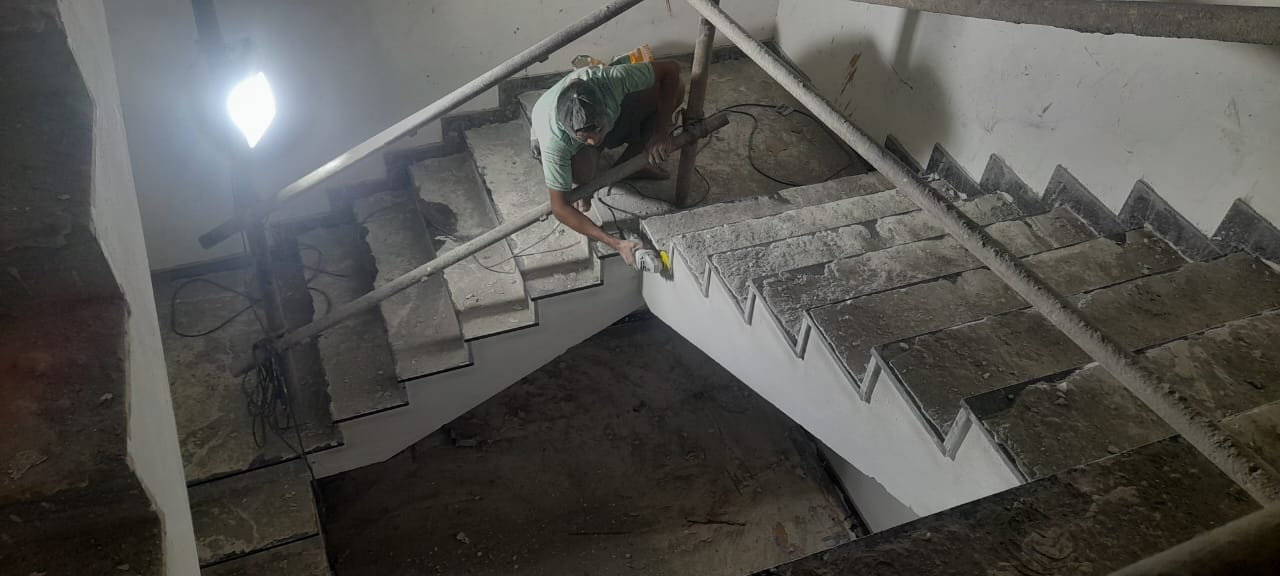

  • General floor work is in progress (16/25 flat completed)

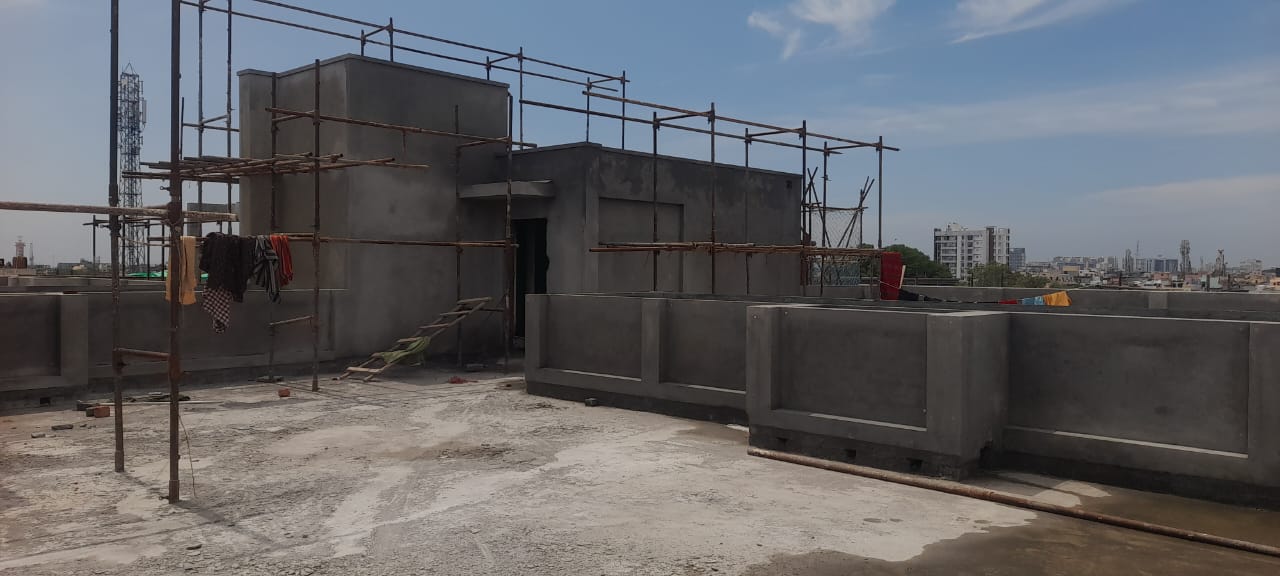

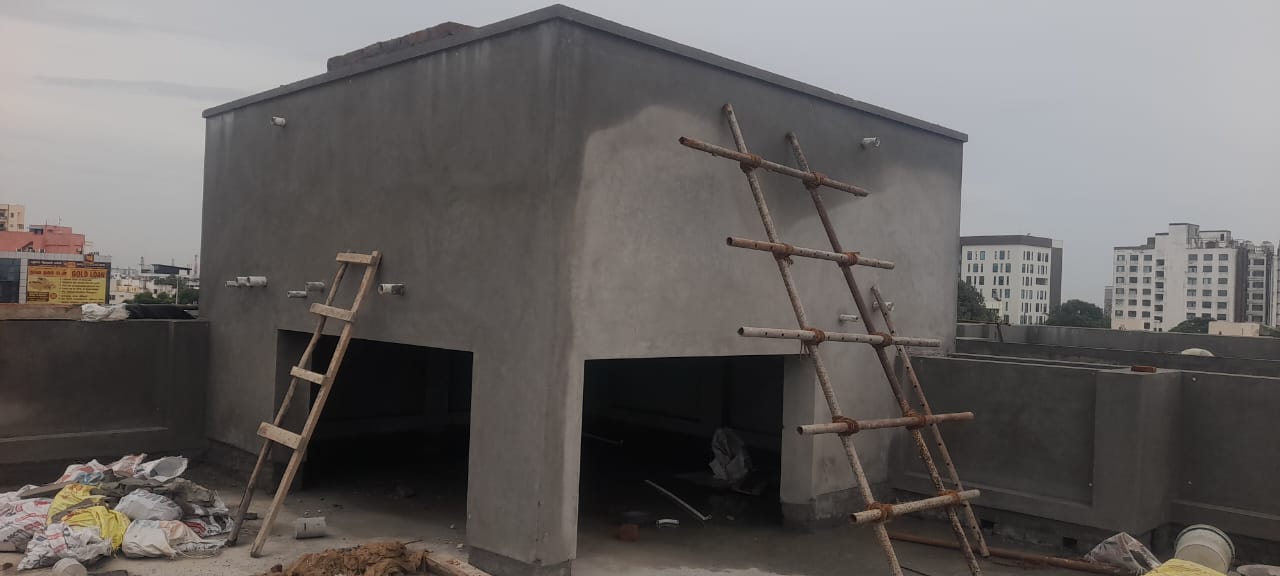

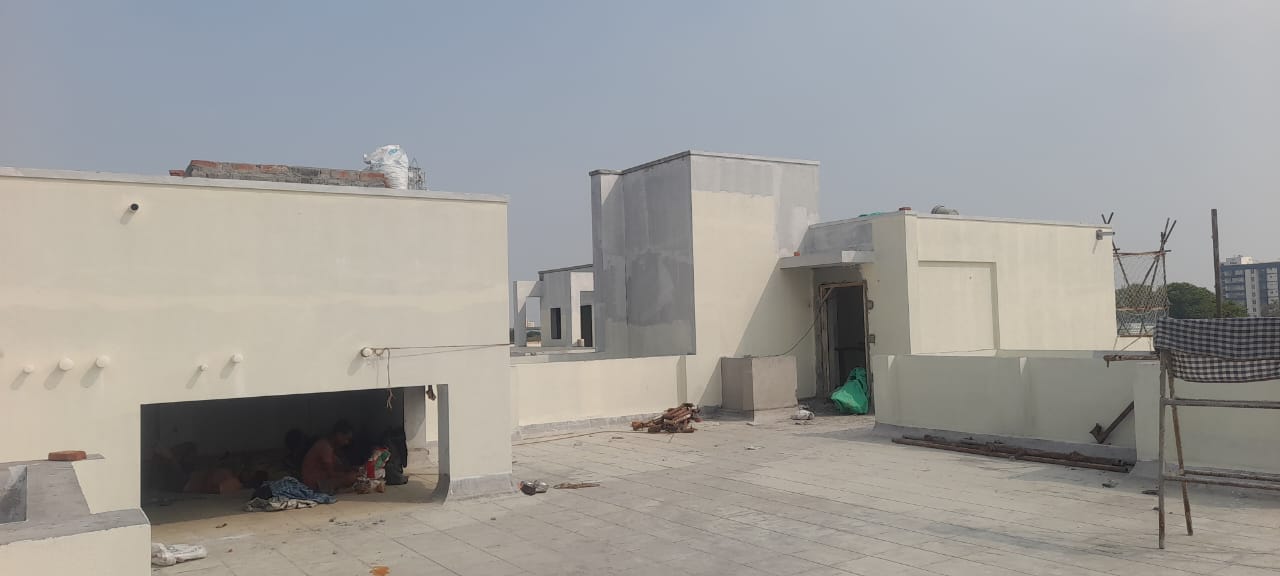

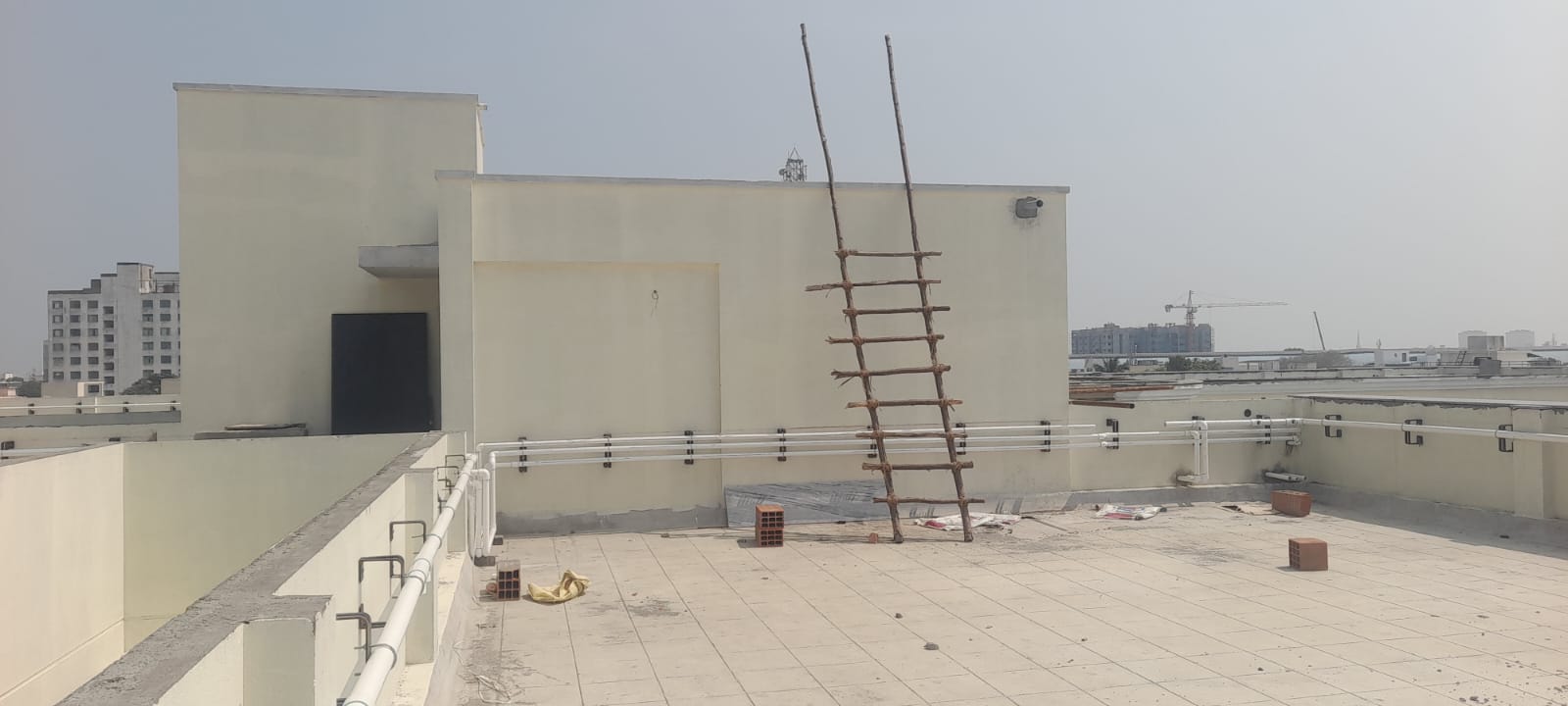

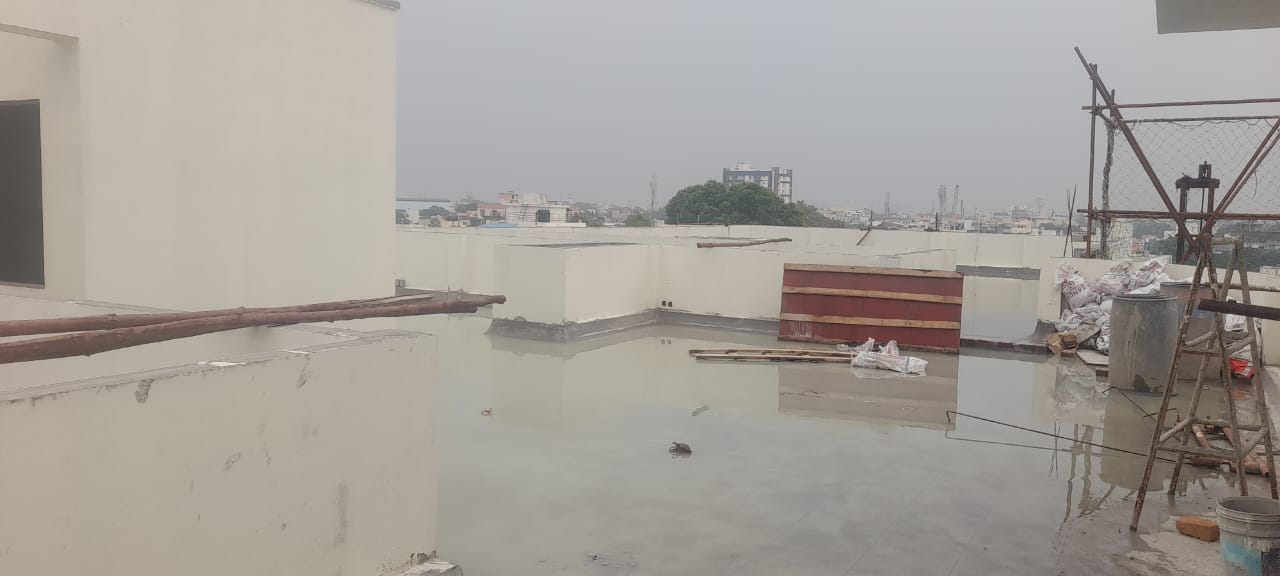

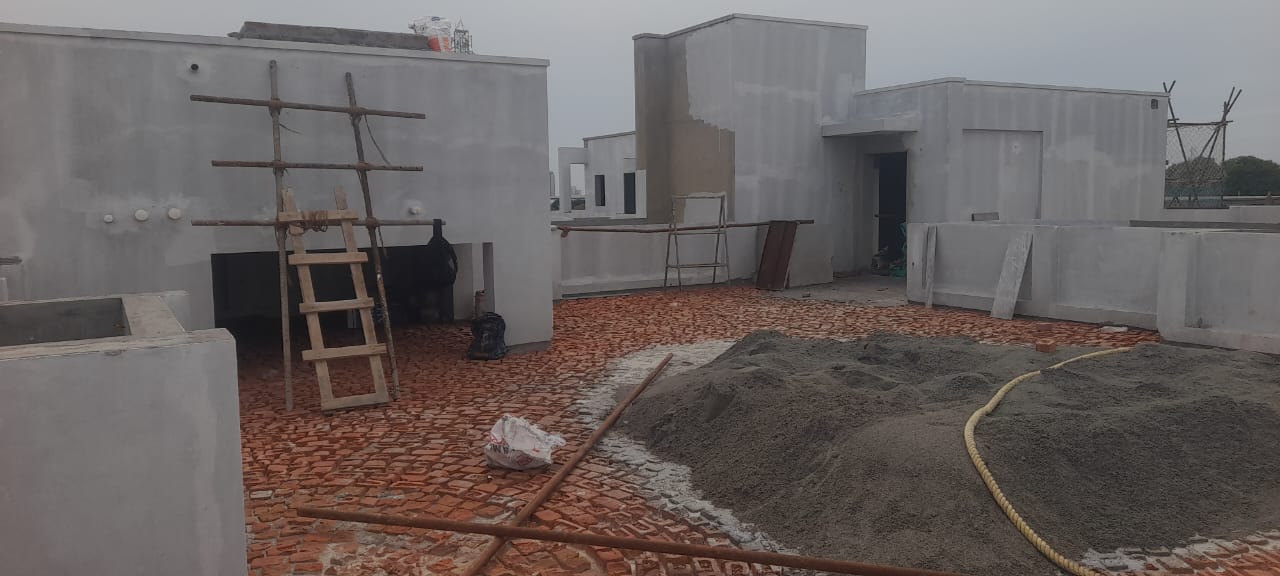

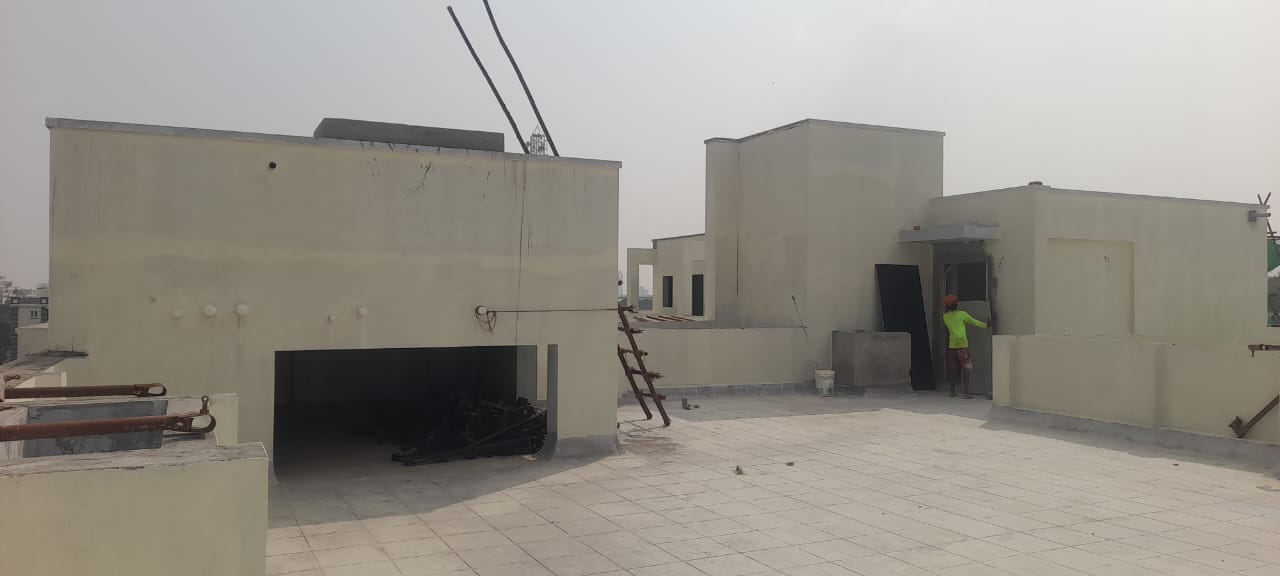

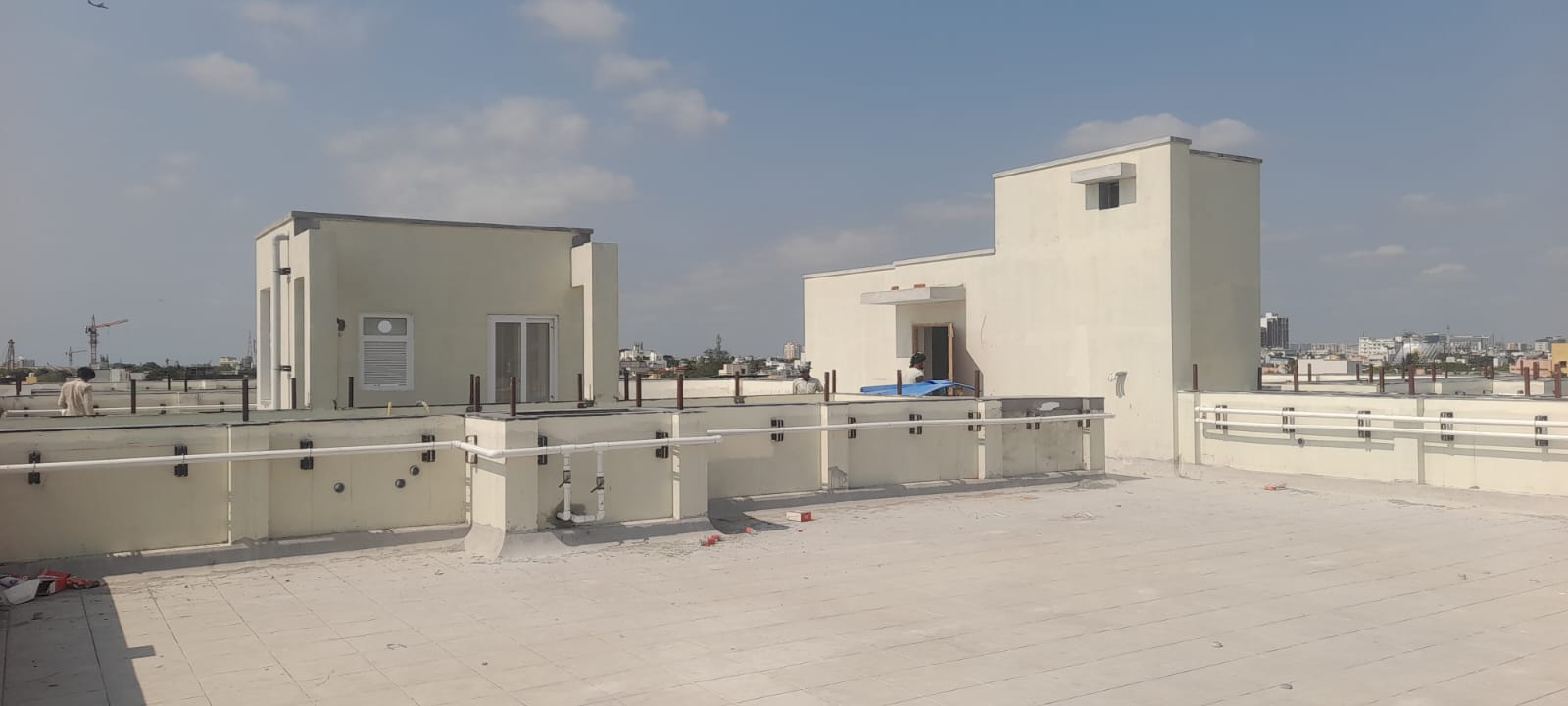

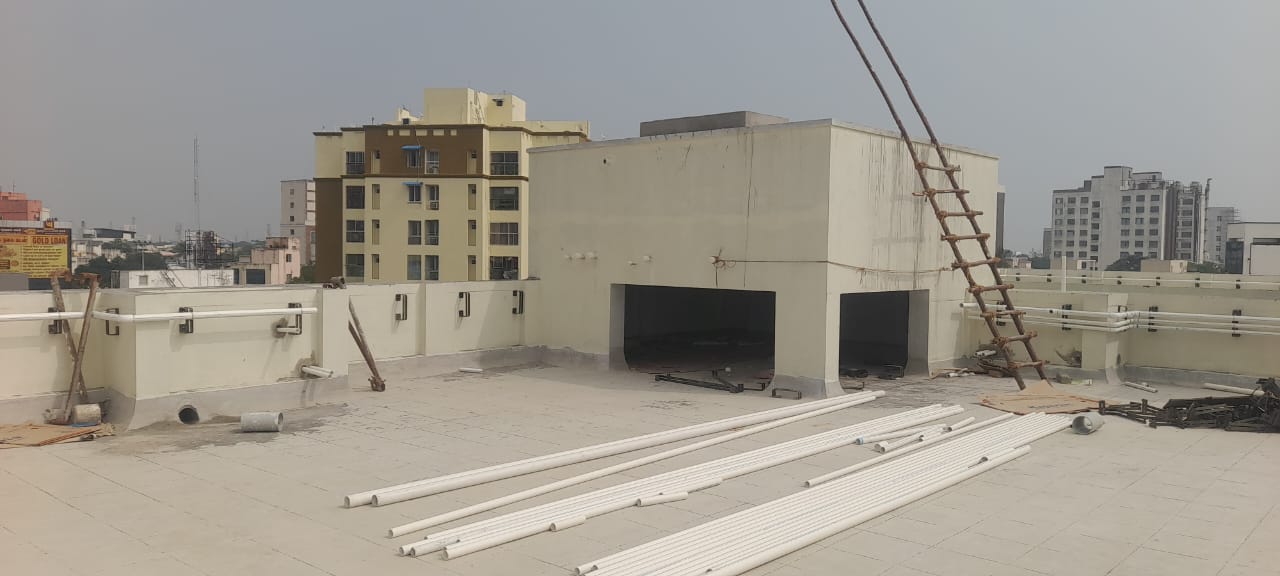

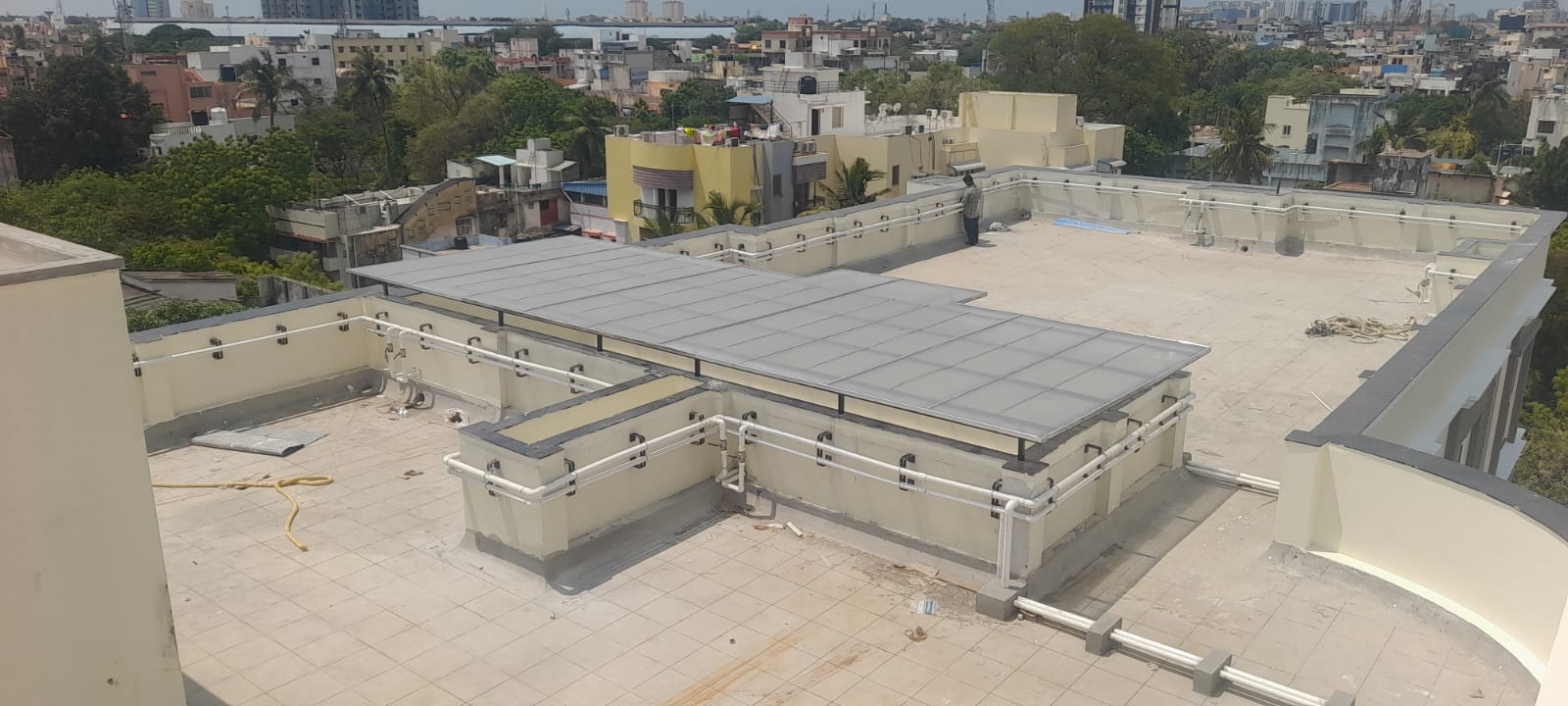

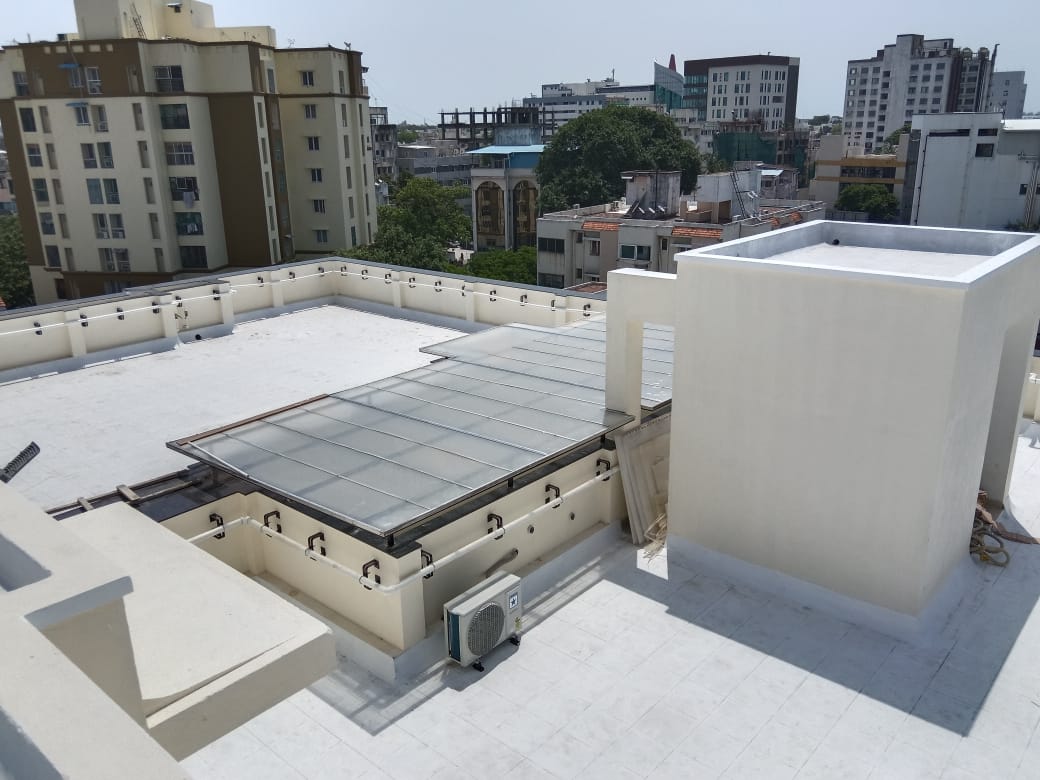

  • Terrace weathering course work is completed.
  • External 1st coat painting work is completed.
  • Toilet plumbing work is completed.(All floor)

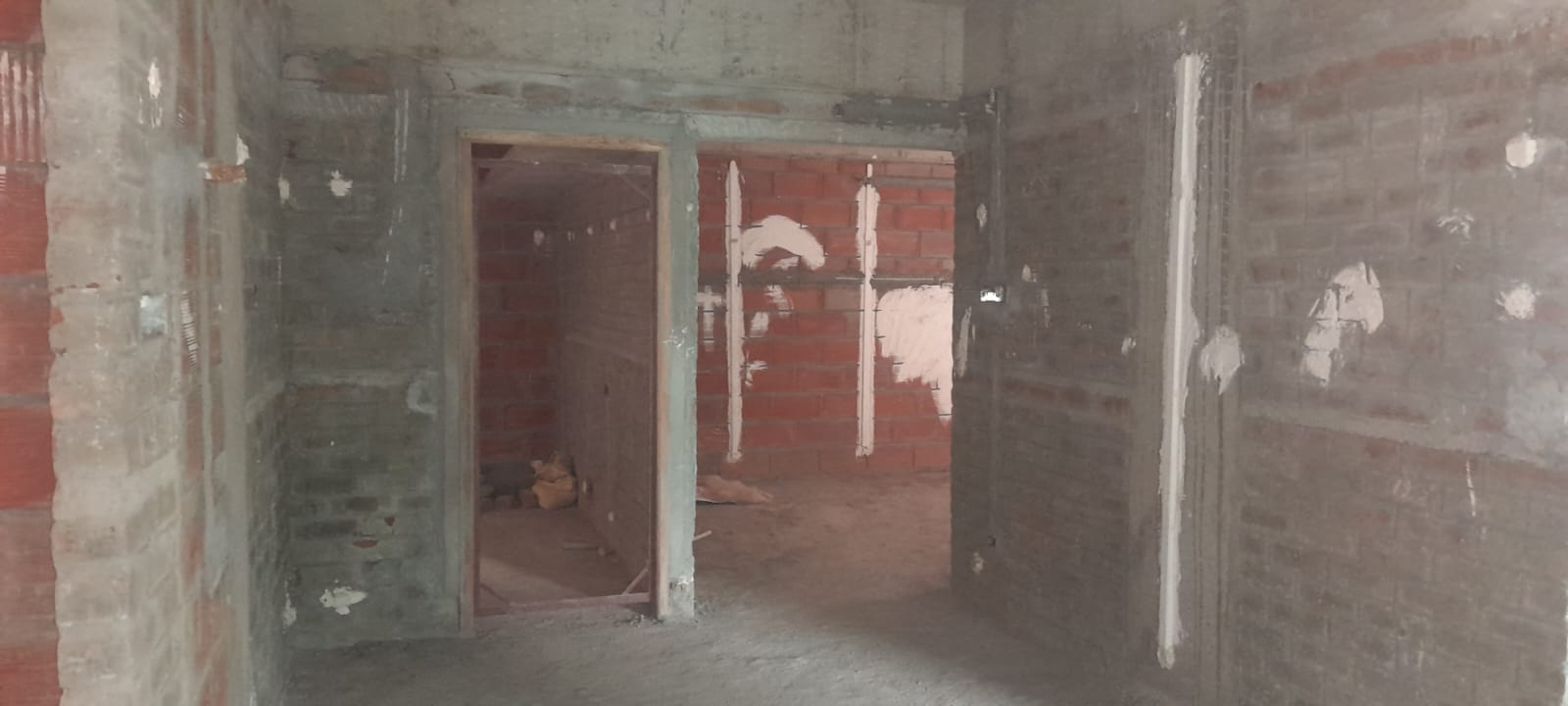

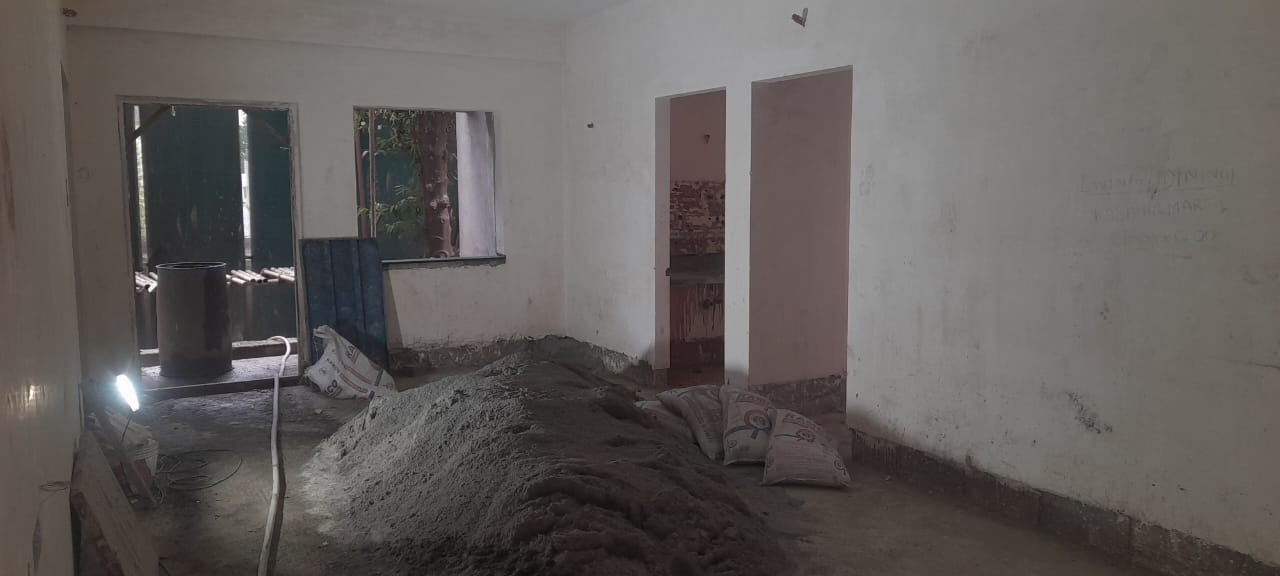

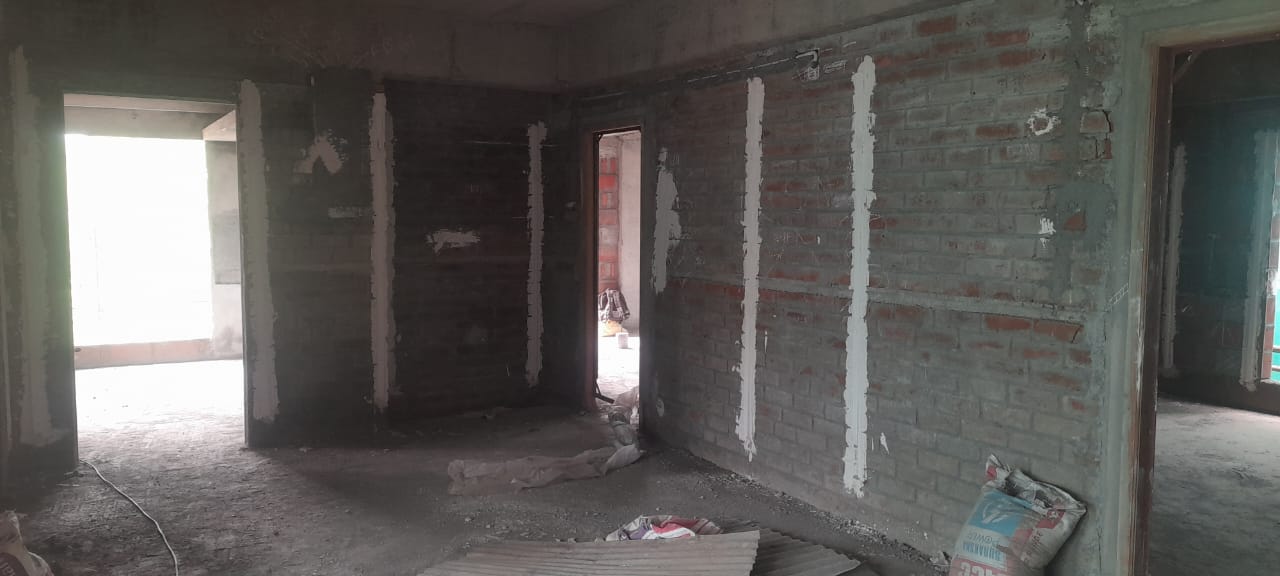

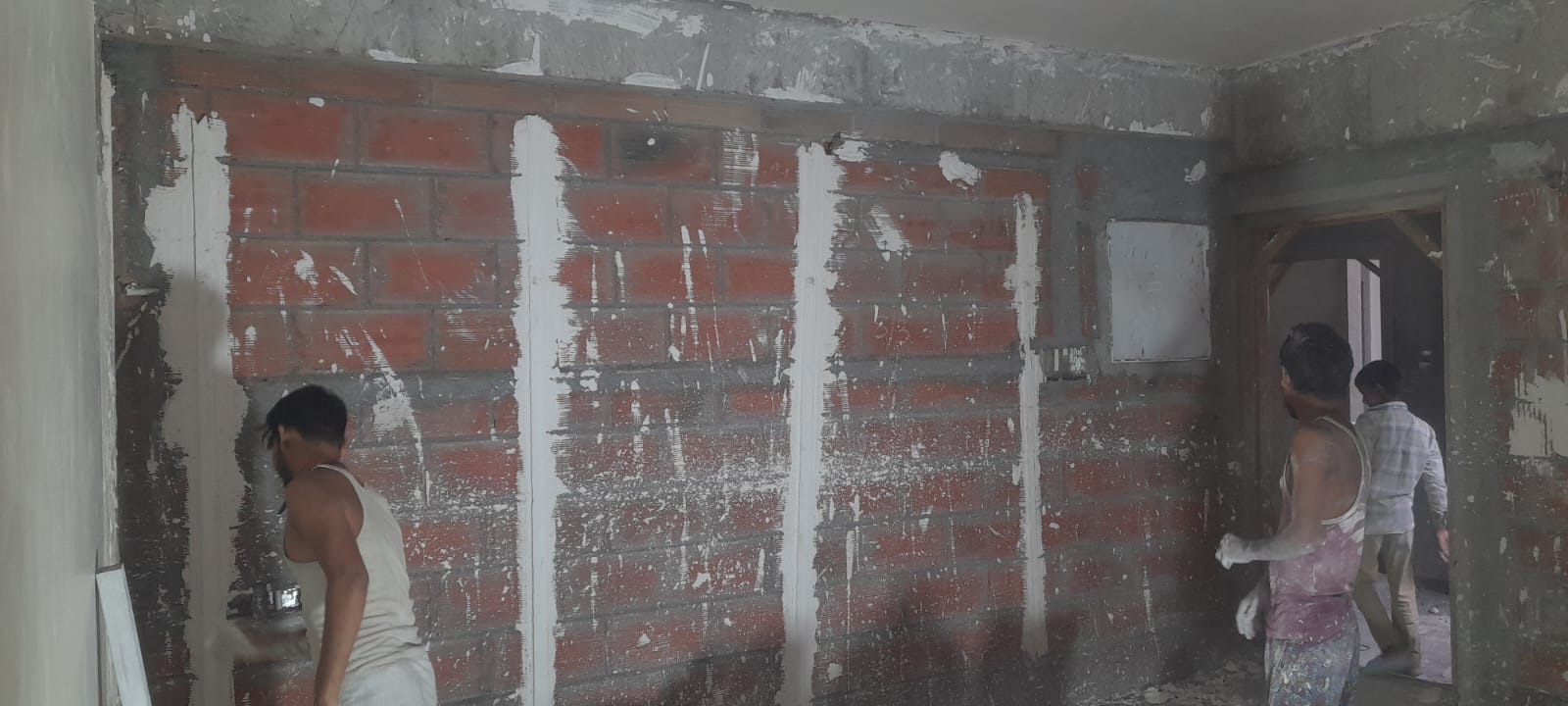

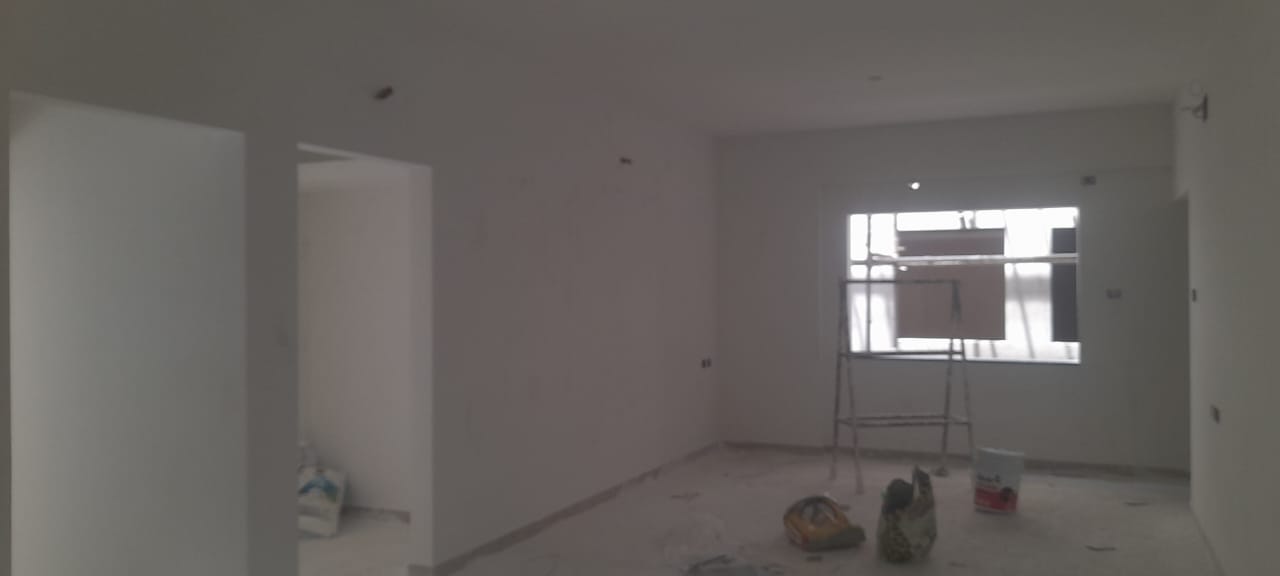

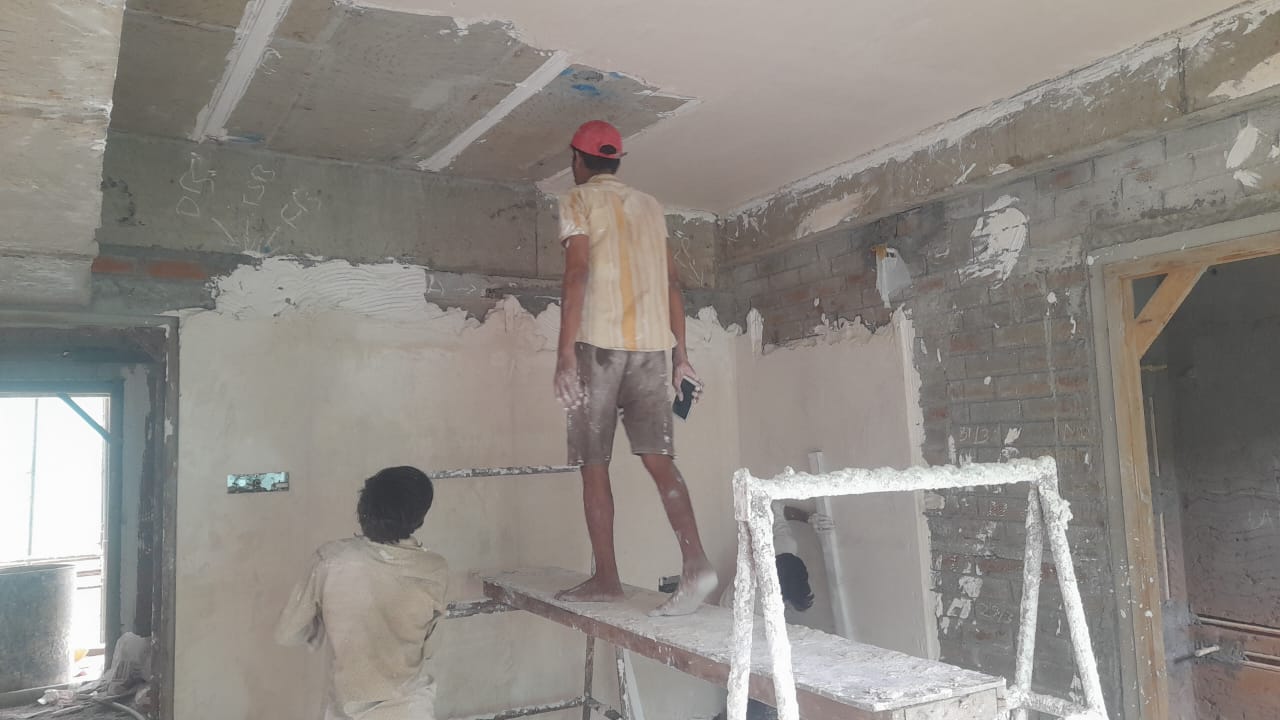

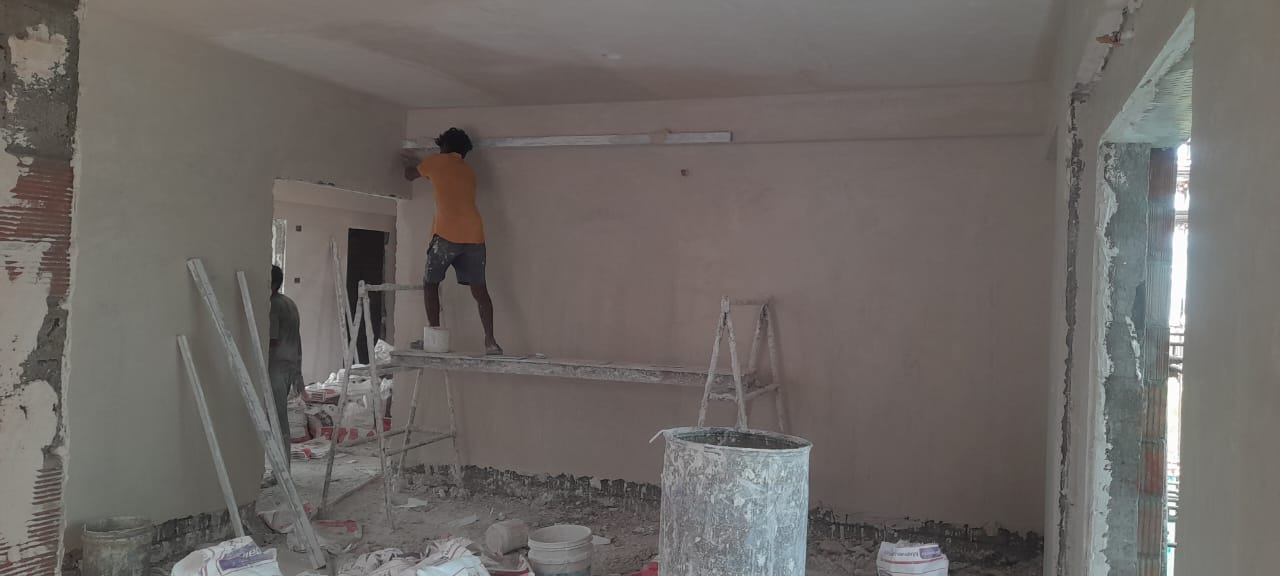

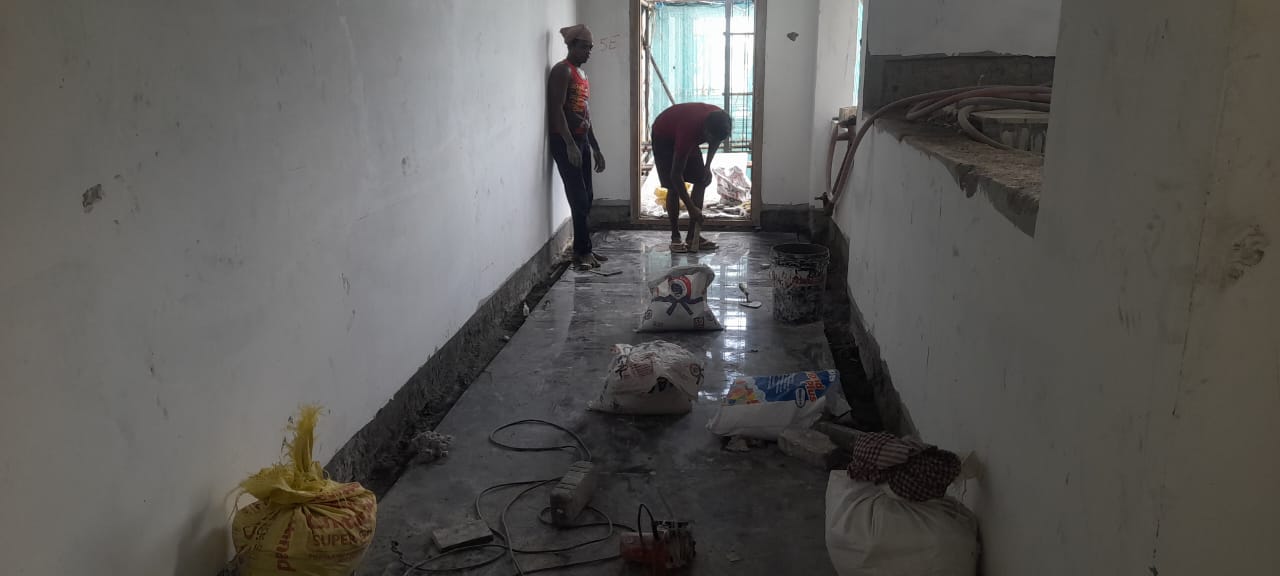

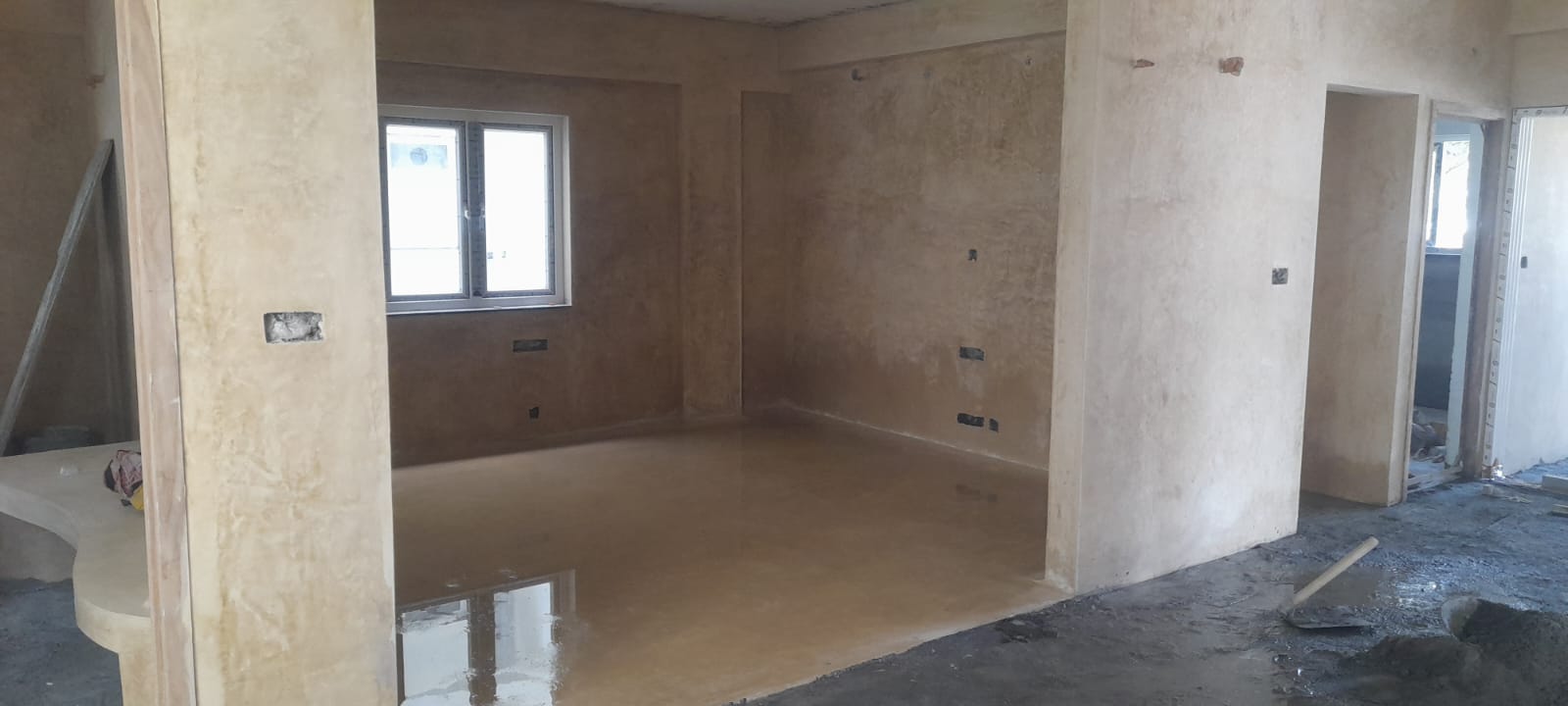

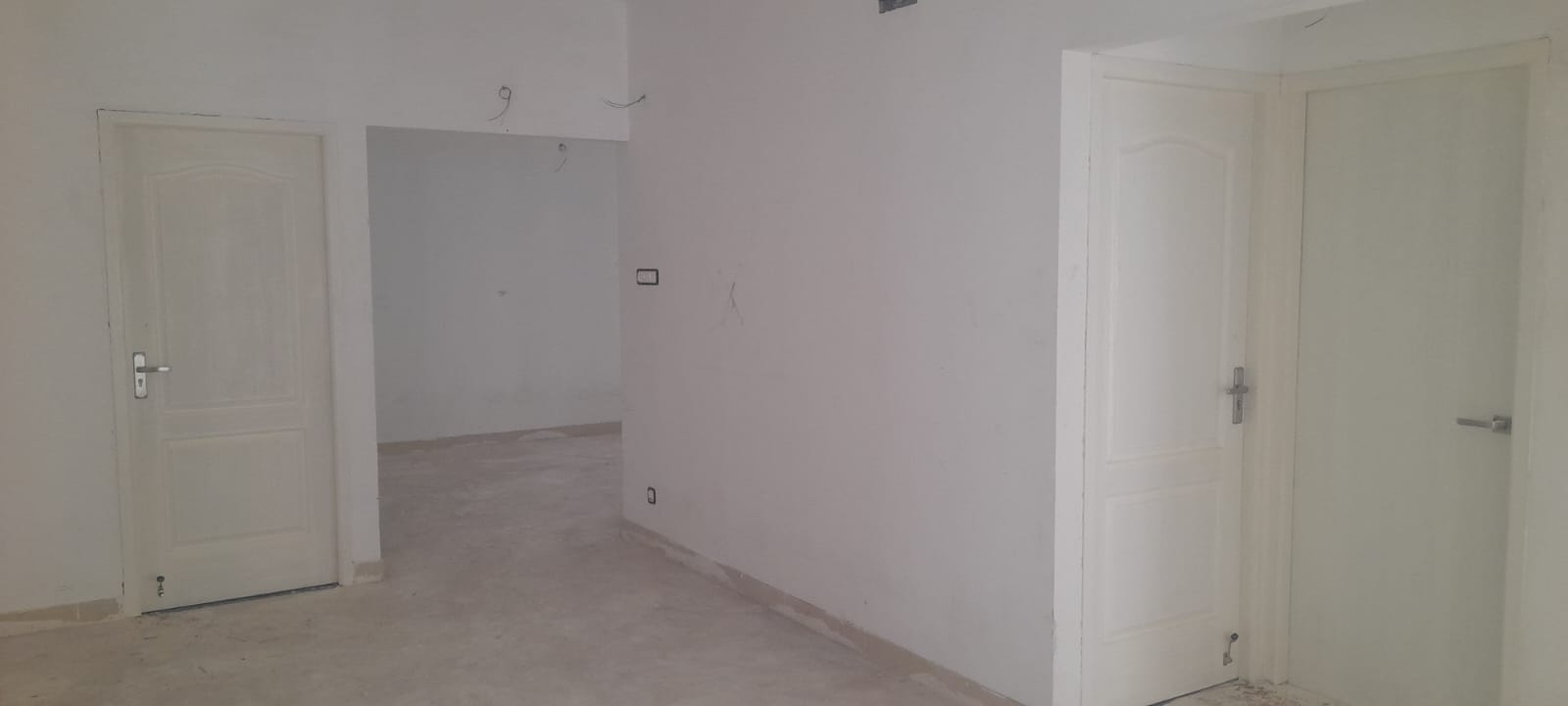

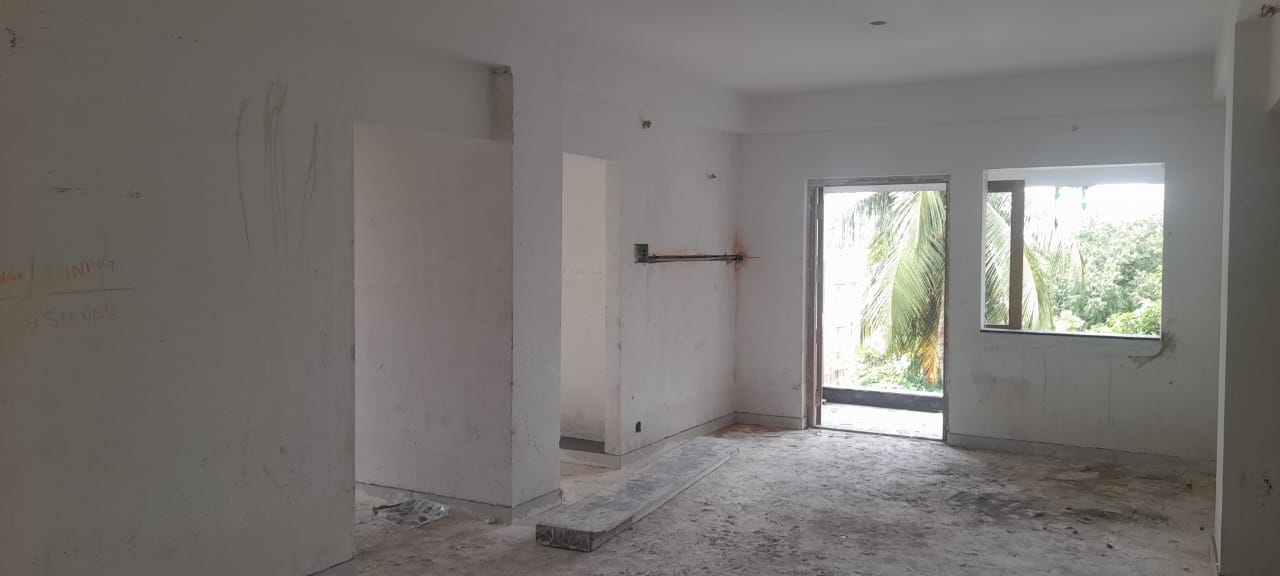

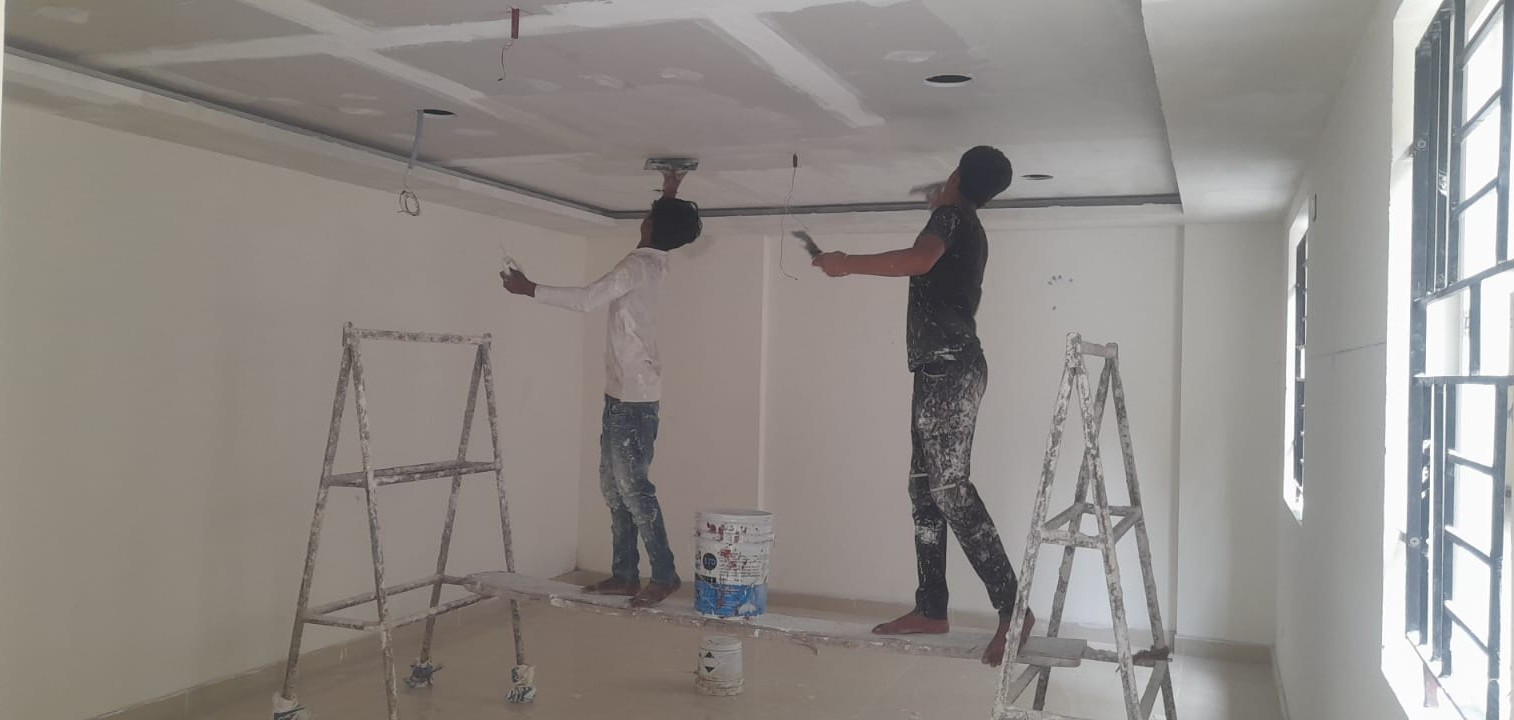

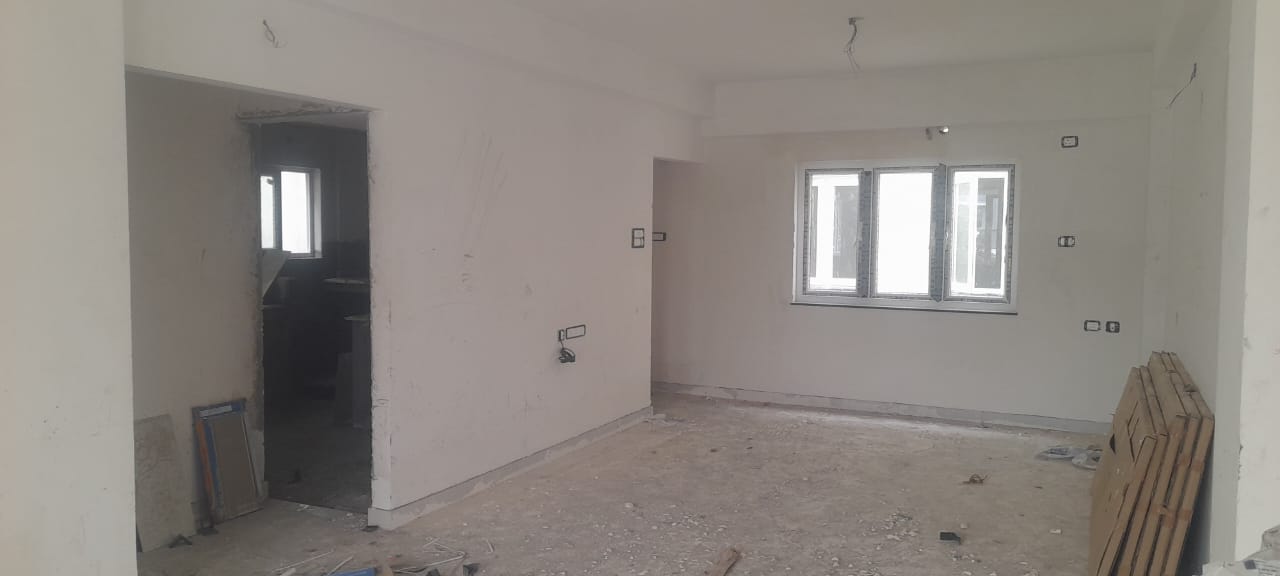

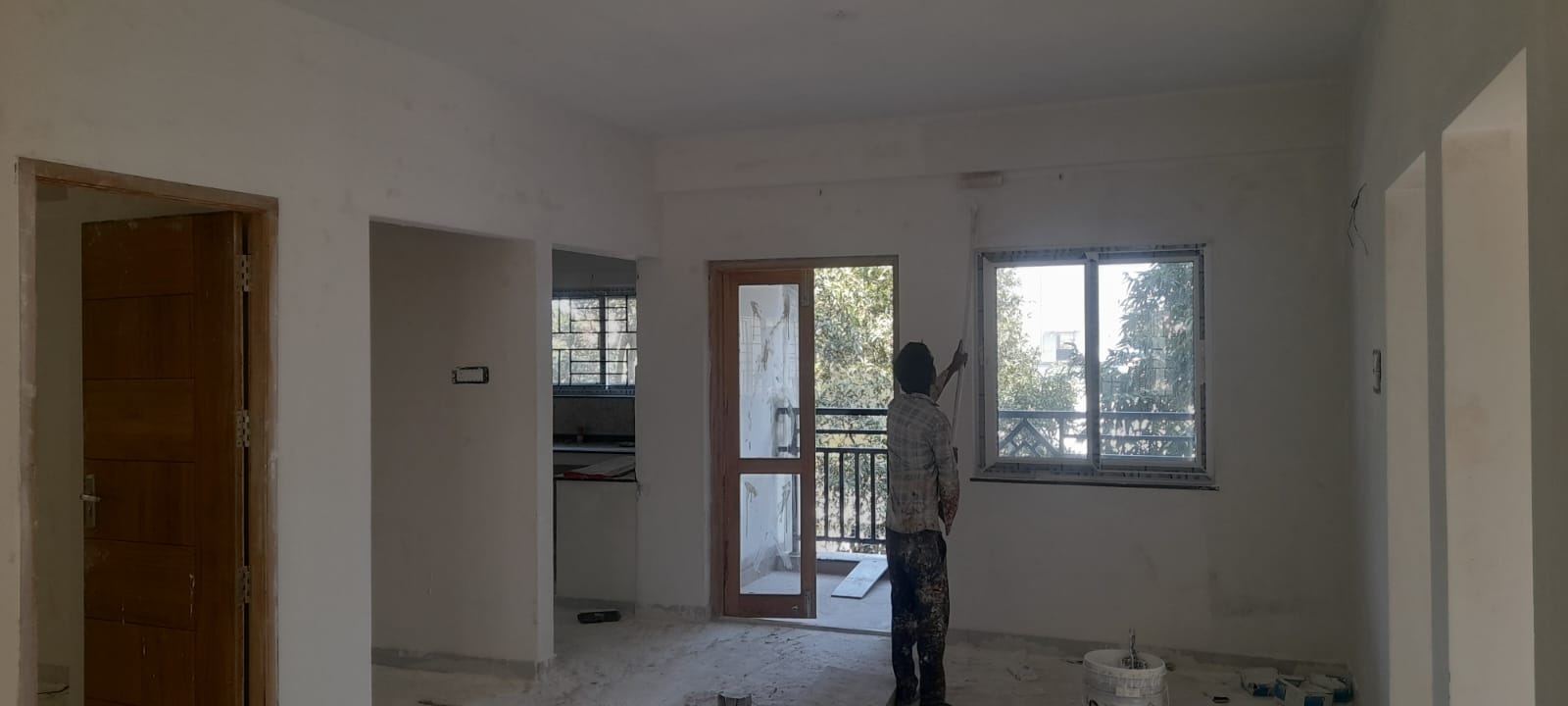

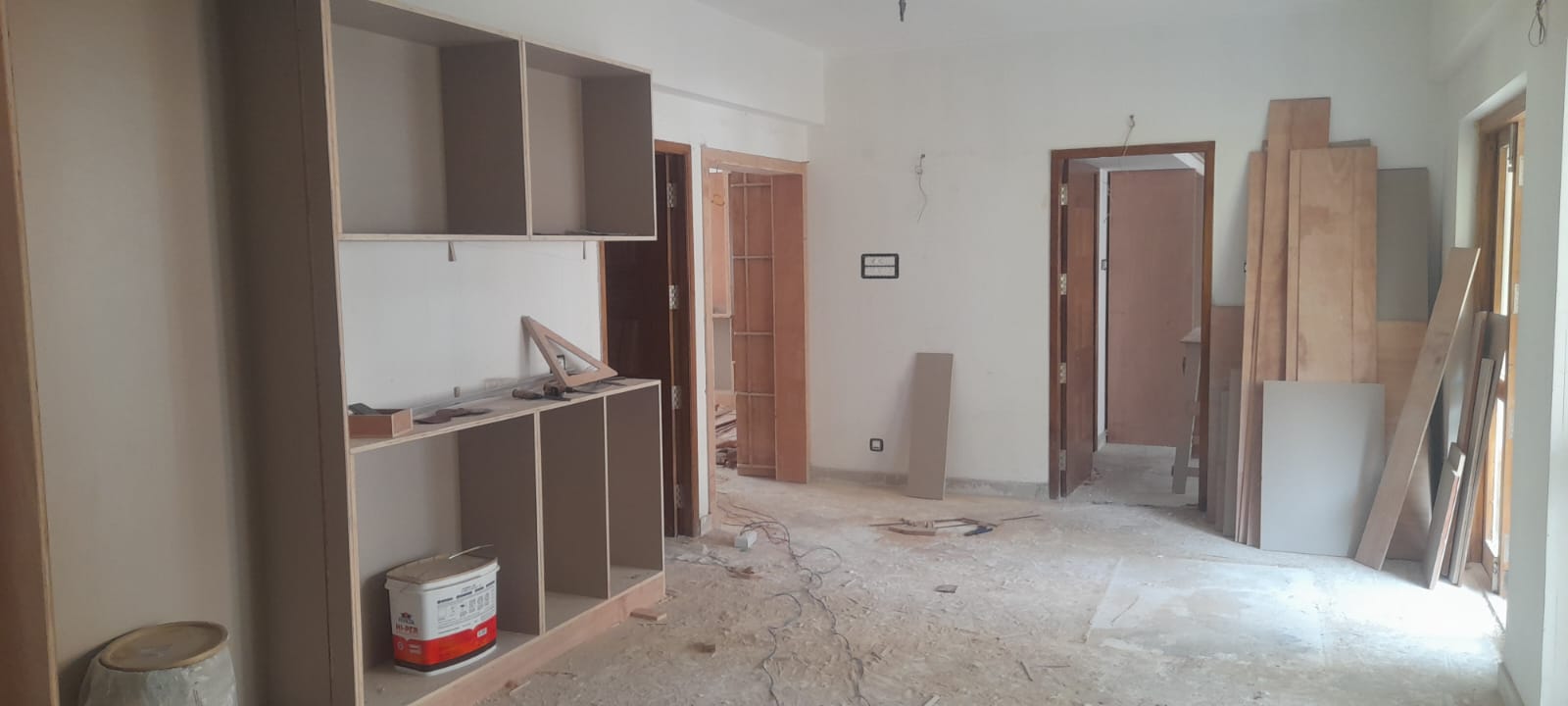

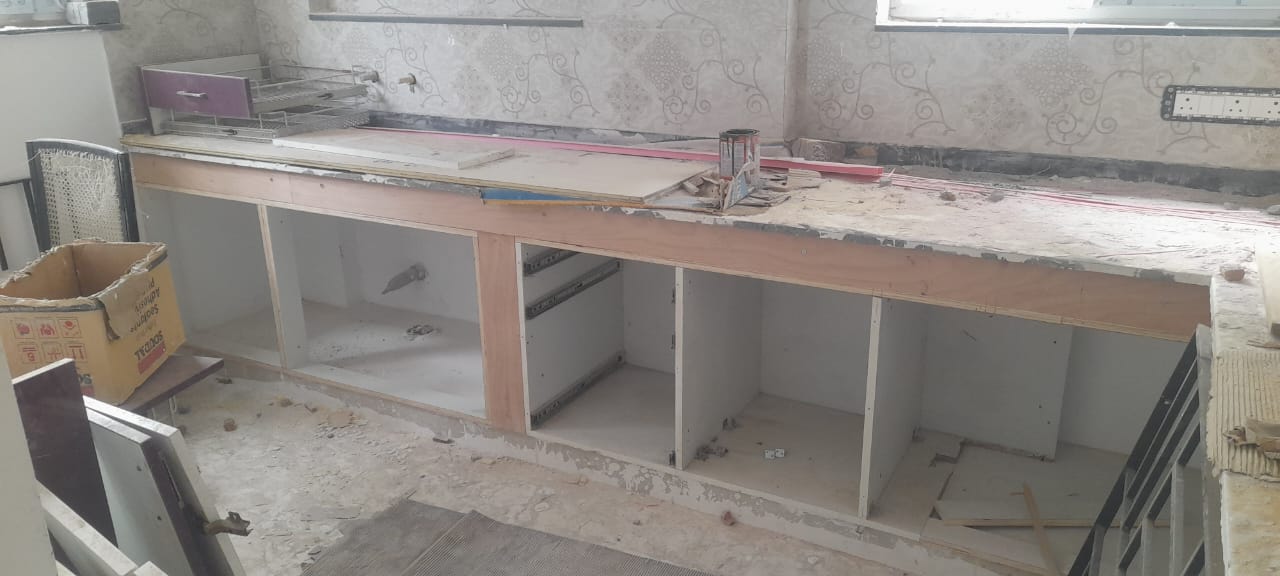

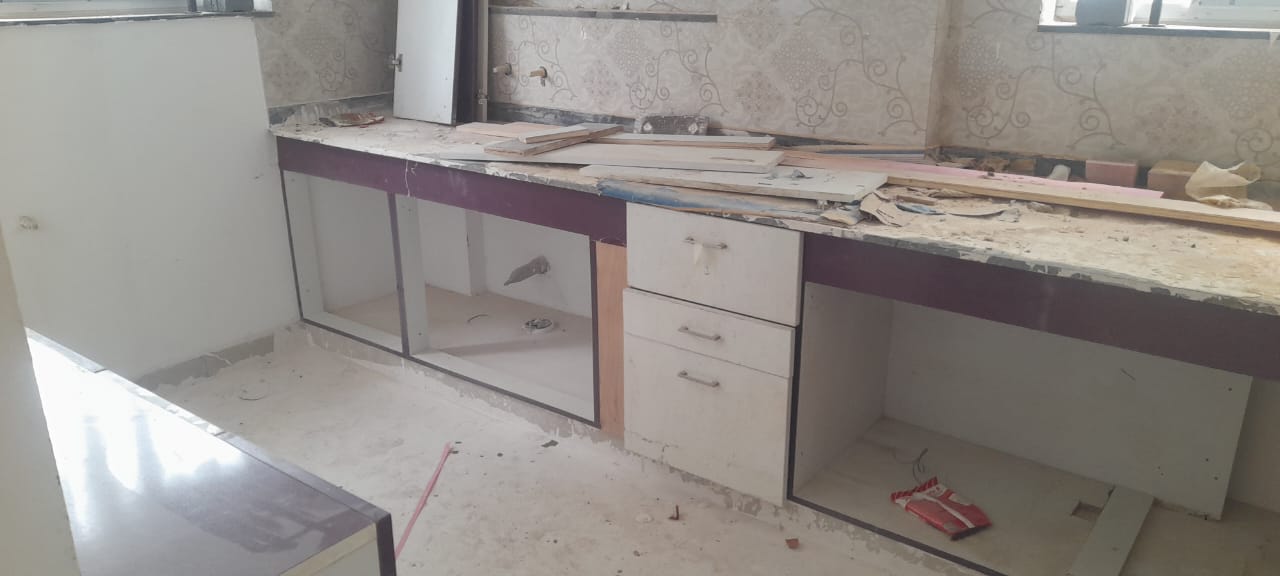

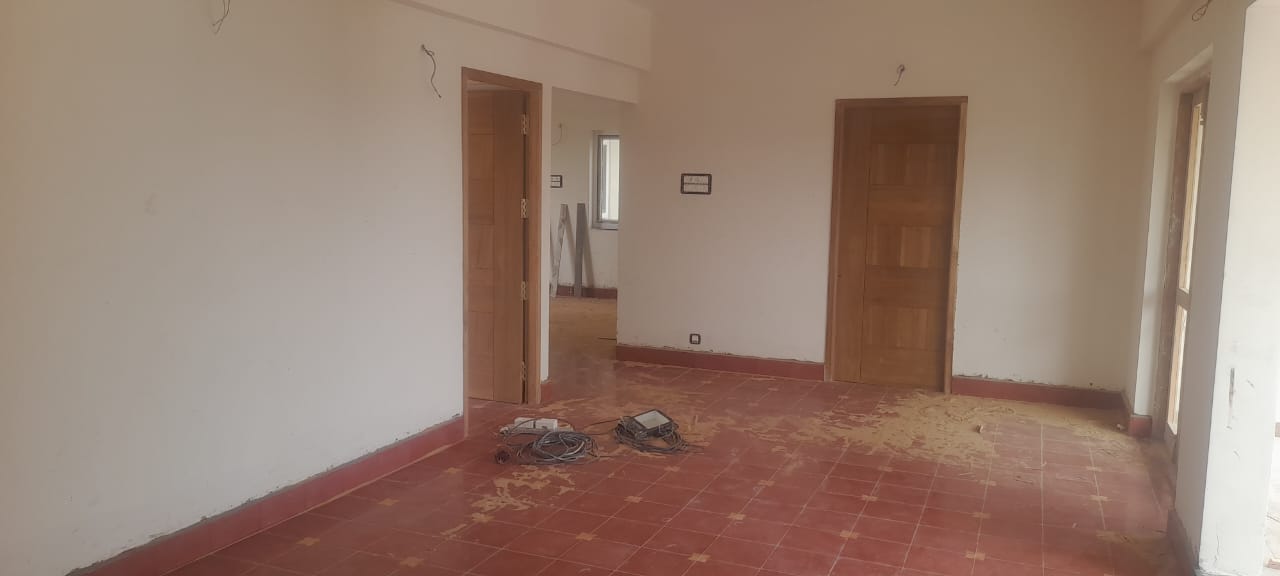

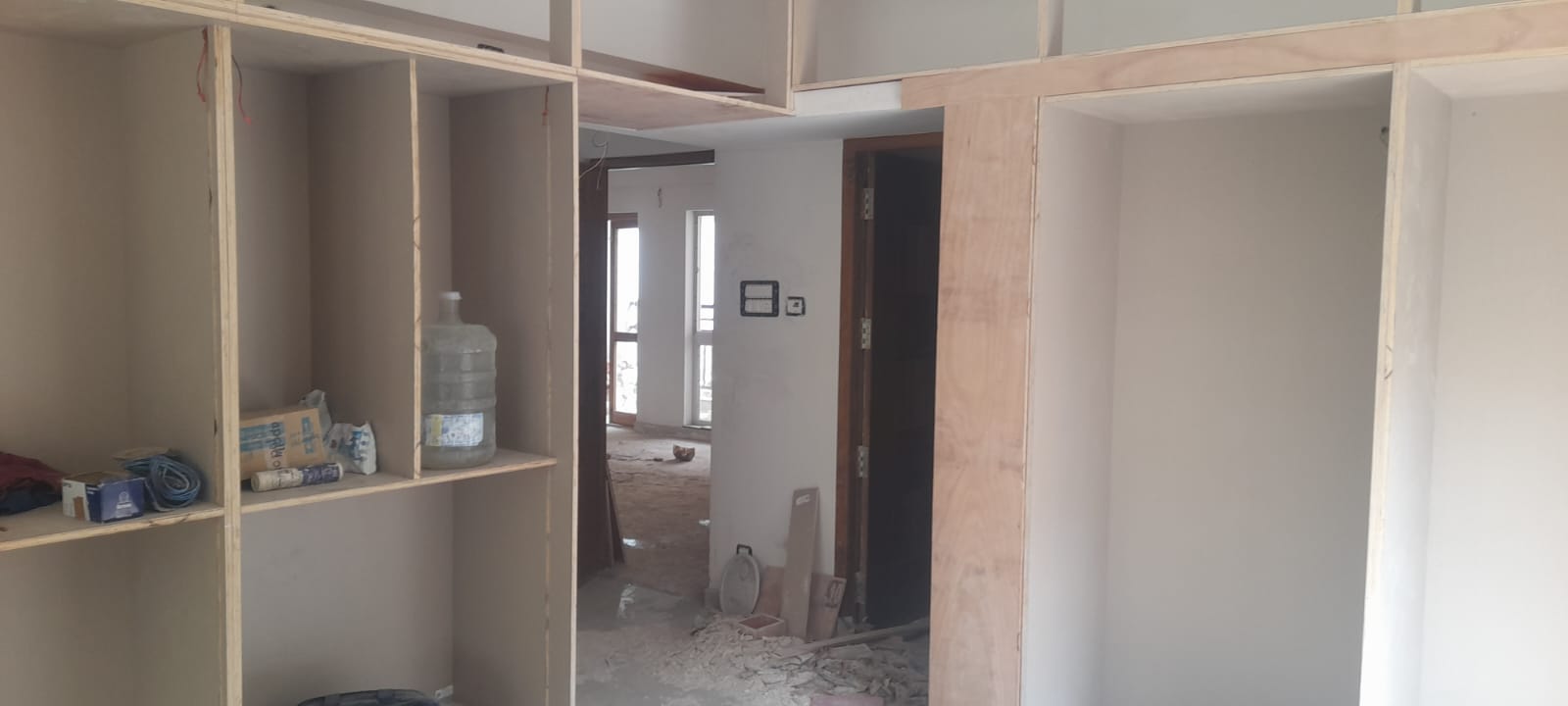

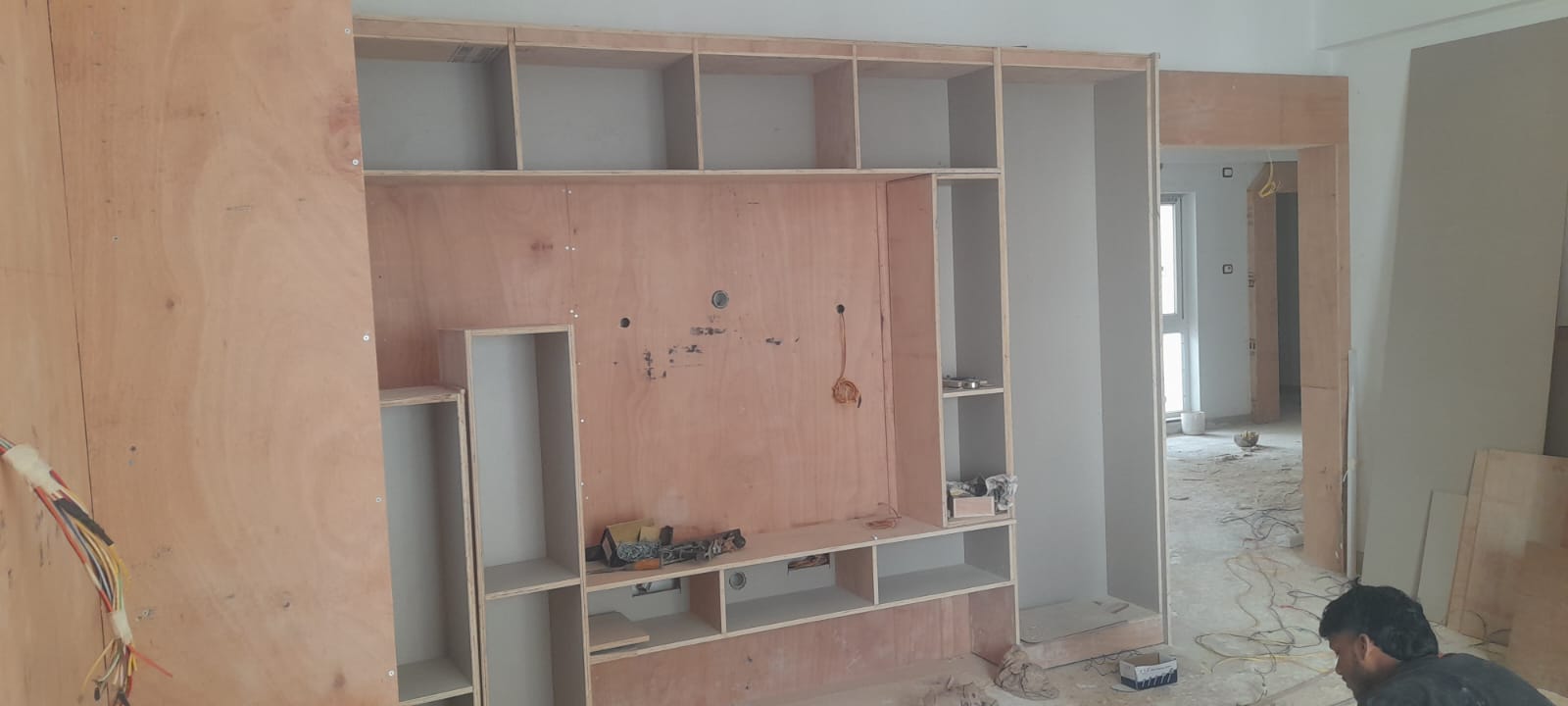

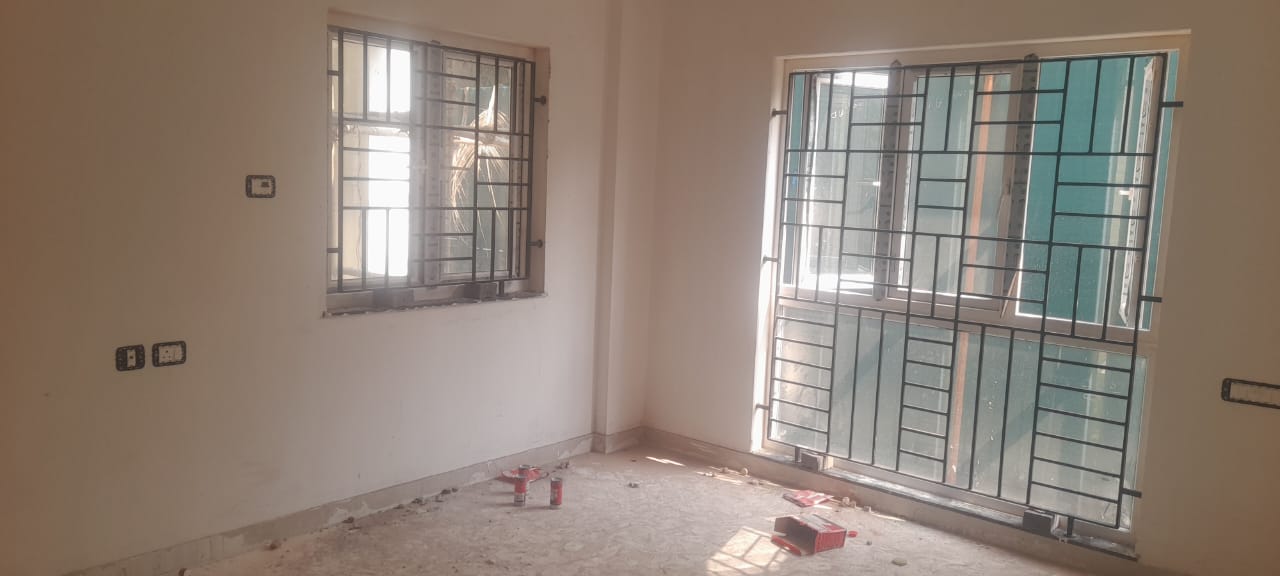

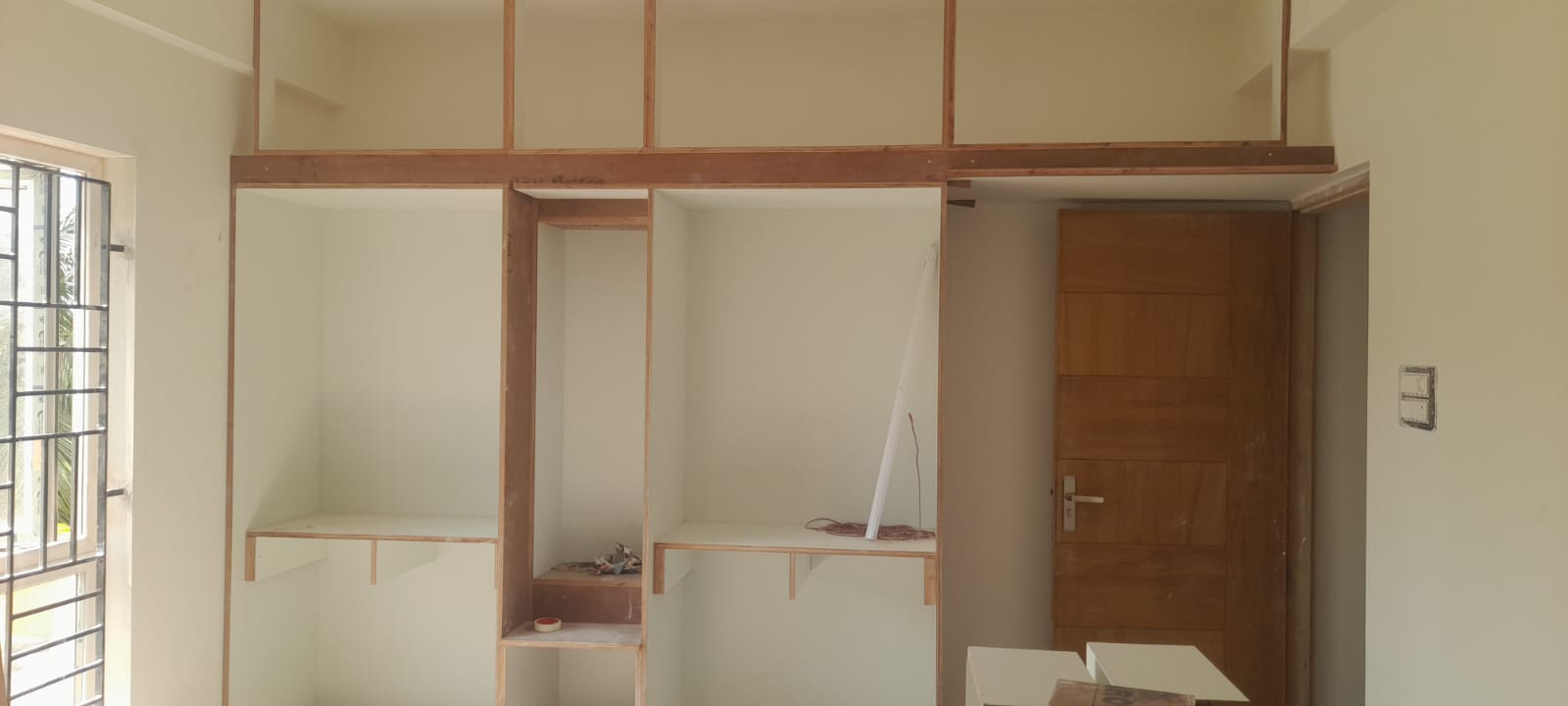

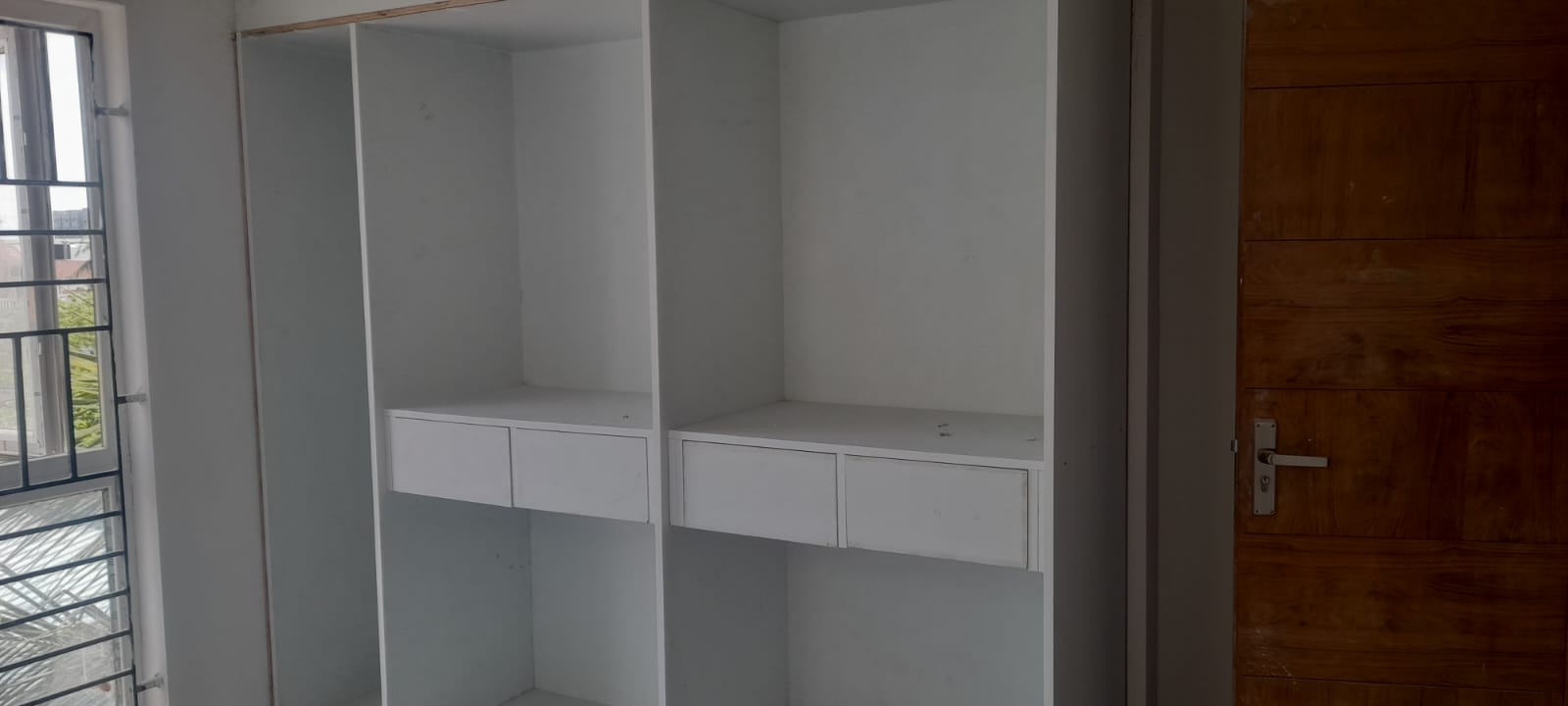

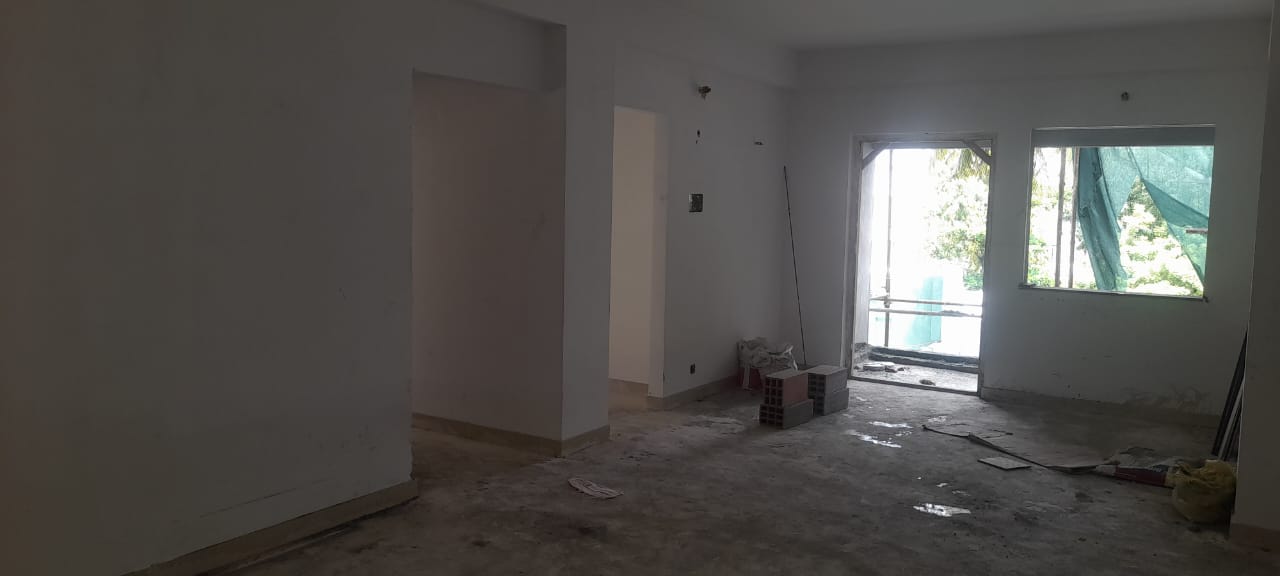

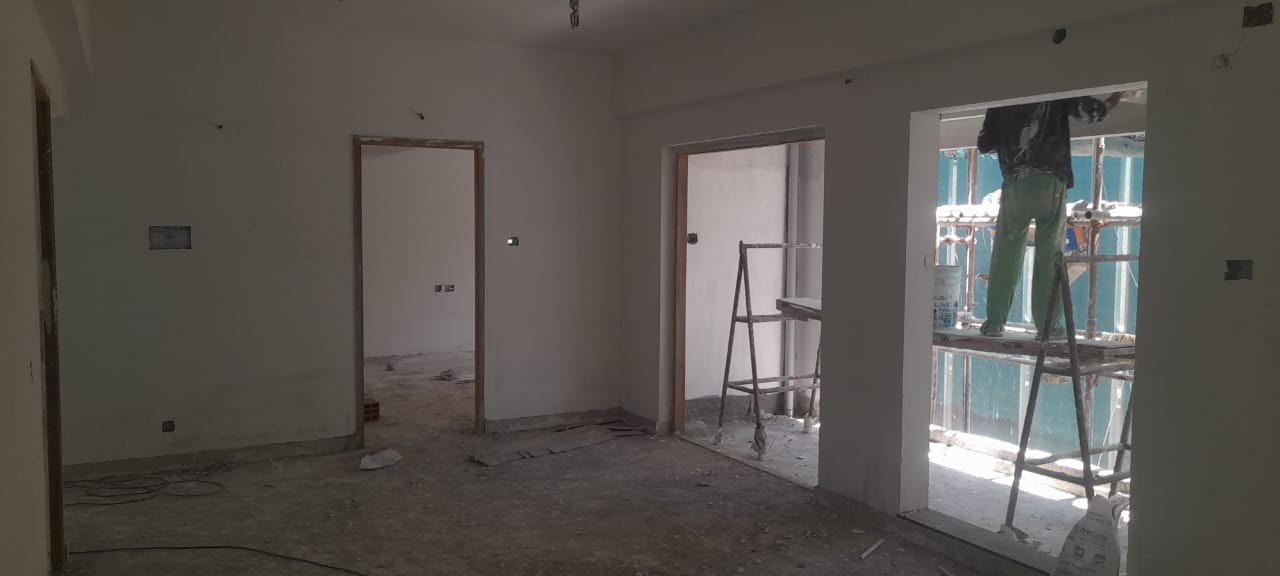

  • Internal putty work is in progress.(up to 4th floor progress)
  • Duct plumbing work is in progress.(50% completed)
