Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Nagas Courtyard

Adyar

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
Multi Purpose Hall

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
1A 1 3BHK + 3T 1420 West Sold Out
2A 2 2BHK + 2T 1420 West Sold Out
3A 1 3BHK + 3T 1420 West Sold Out
5B 5 2BHK + 2T 1129 West Sold Out
`3B 1 2BHK + 2T 1129 West Sold Out
4A 4 3BHK + 3T 1420 West Sold Out
5A 5 3BHK + 3T 1420 West Sold Out
4B 4 2BHK + 2T 1129 West Sold Out
2B 2 2BHK + 2T 1129 West Sold Out
1B 1 2BHK + 2T 1129 West Sold Out

Approvals

Planning Permit No:

OL - PP / NHRB / 0318 / 2023

Date of Permit:

2023-08-17

Building Permission No:

CEBA / WDCN13 / 00333 / 2023

Date of Permit:

2023-09-05

TNRERA:

TN / 29 / Building / 0420 / 2023

Dated:

2023-10-11

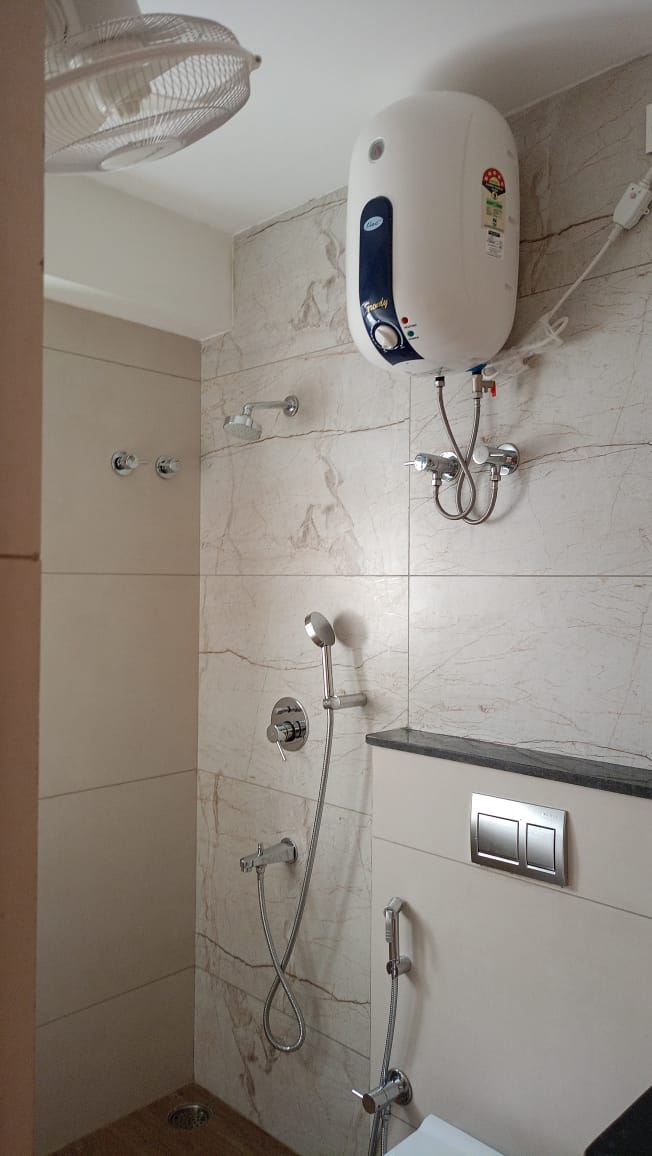

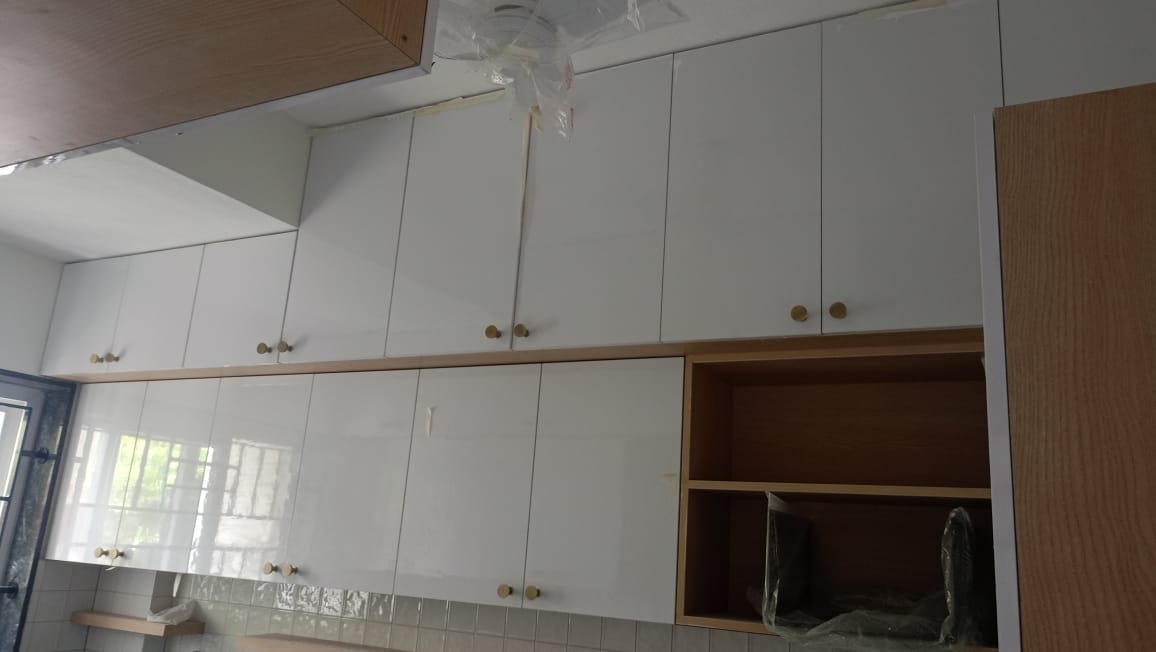

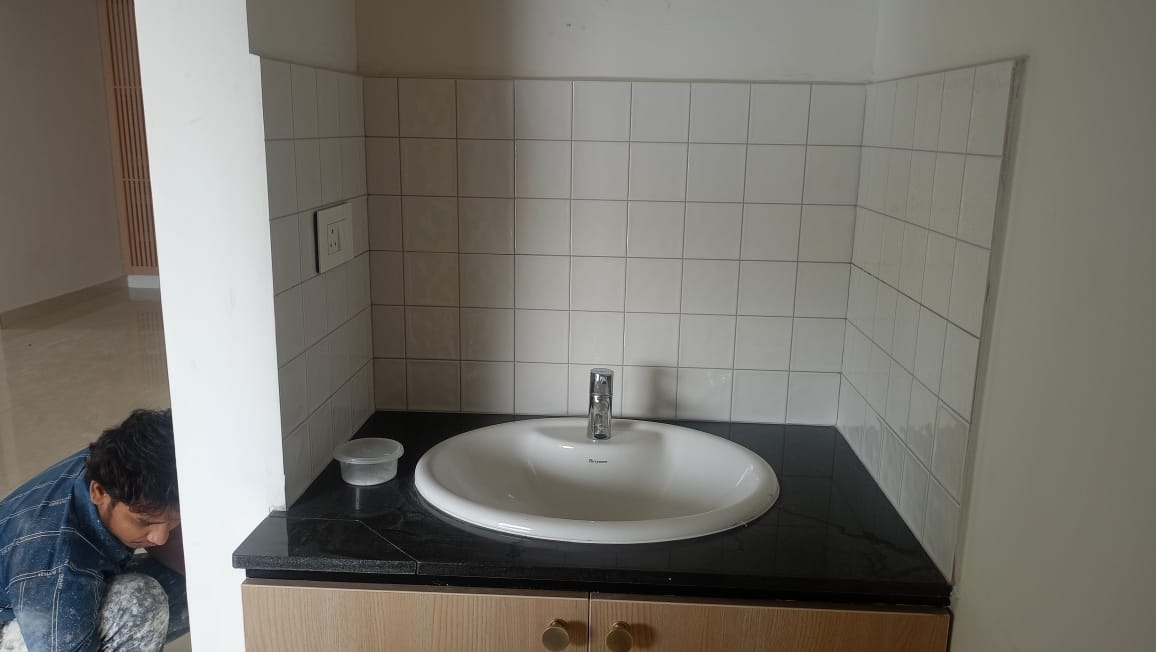

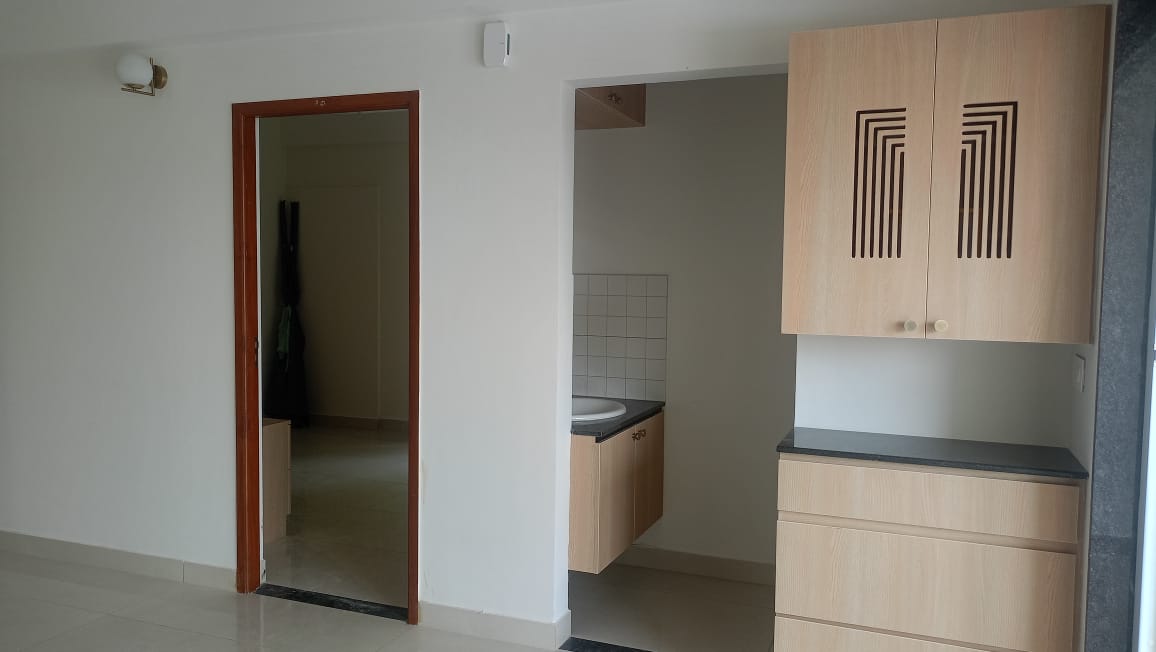

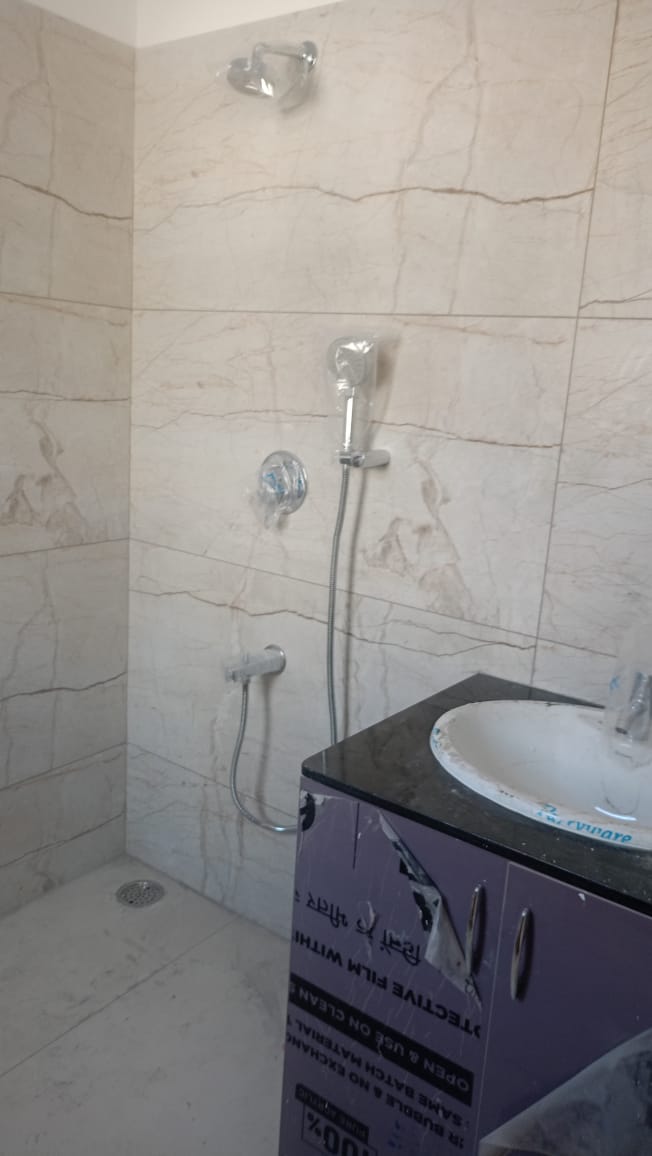

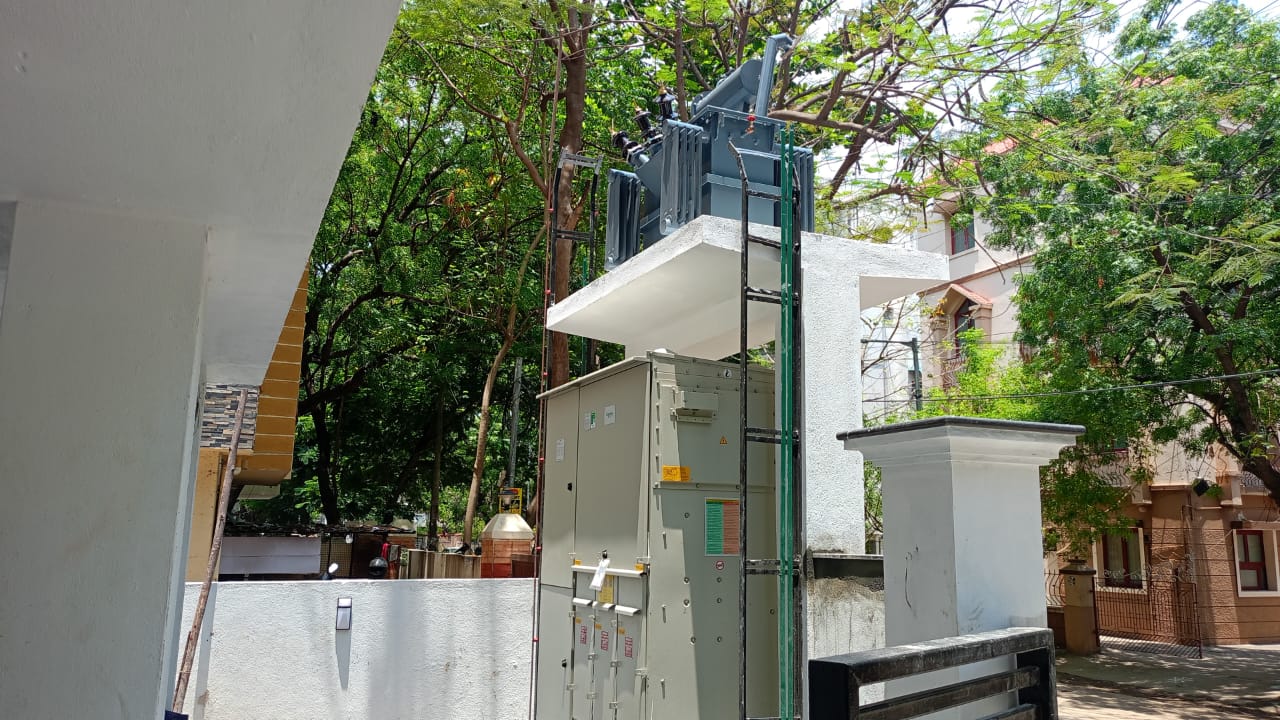

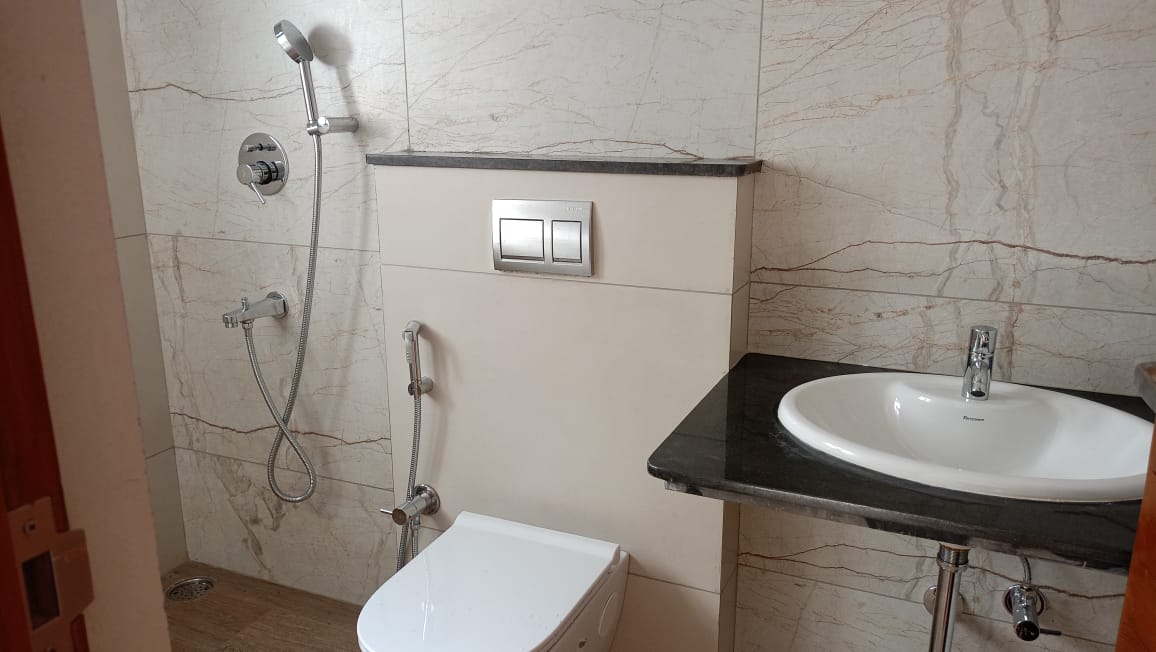

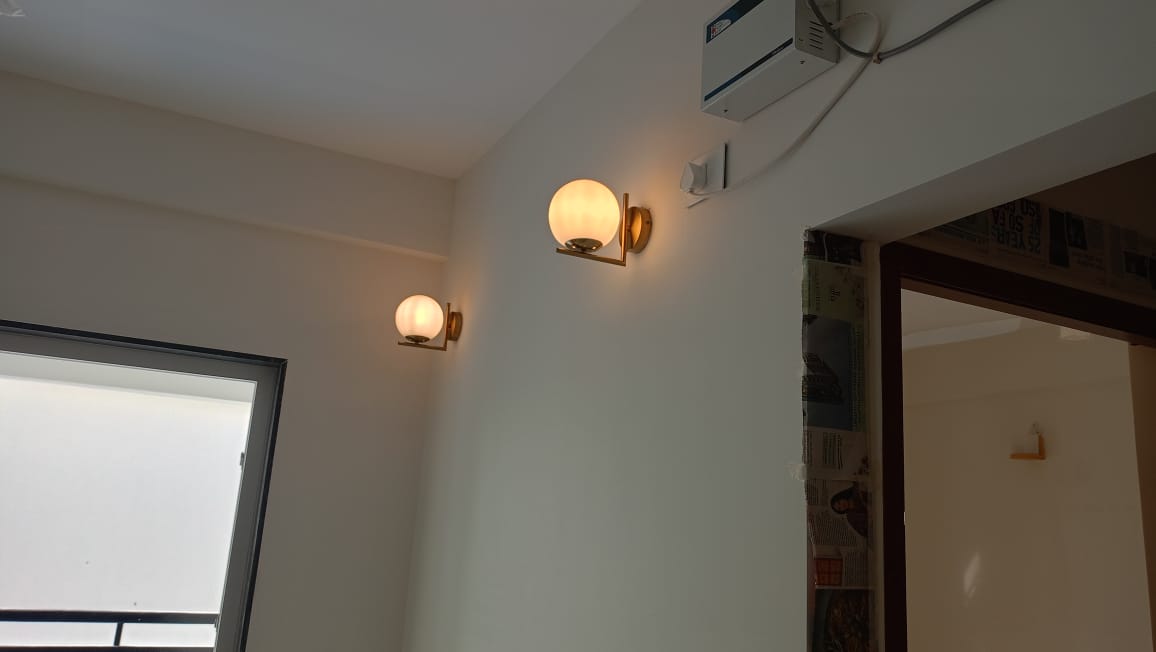

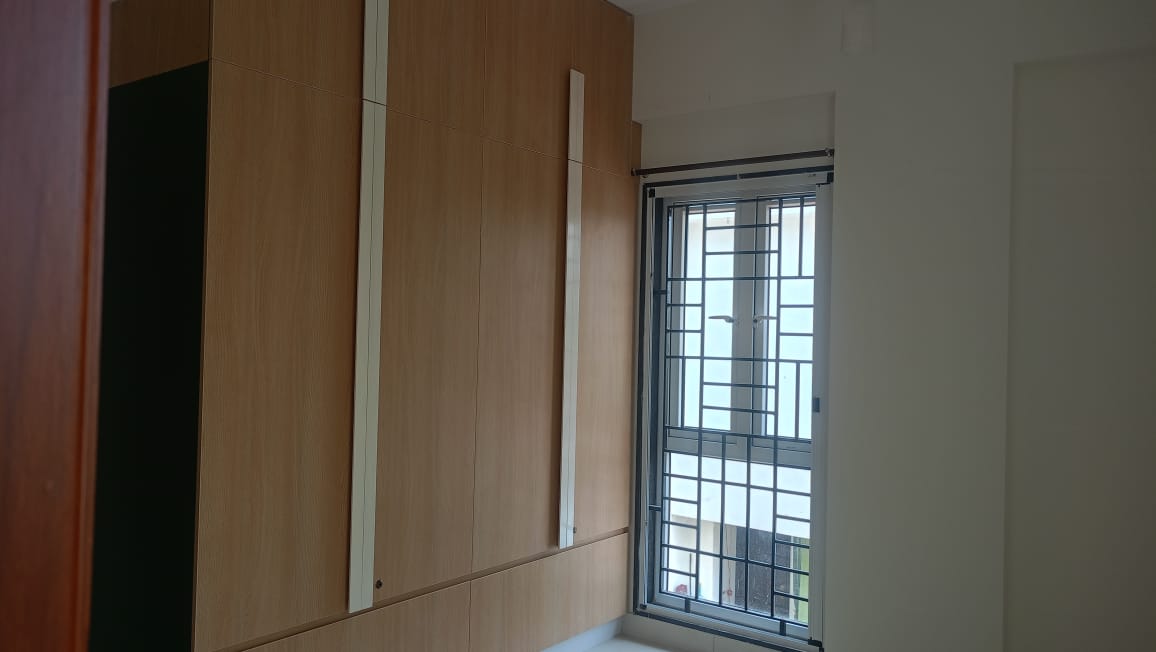

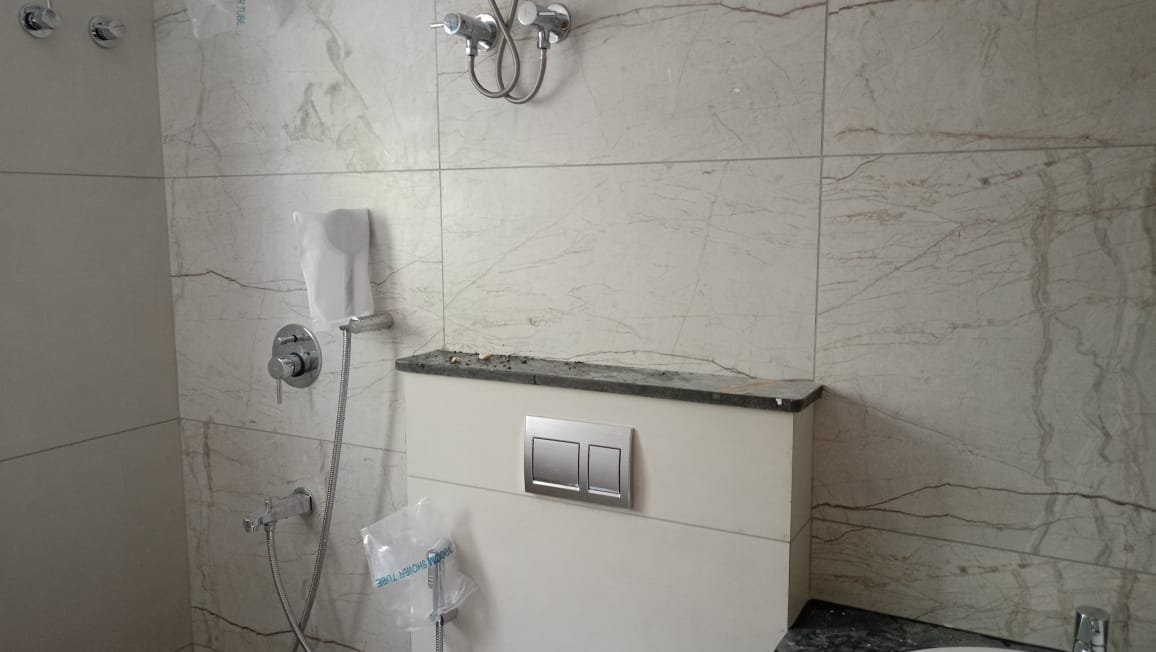

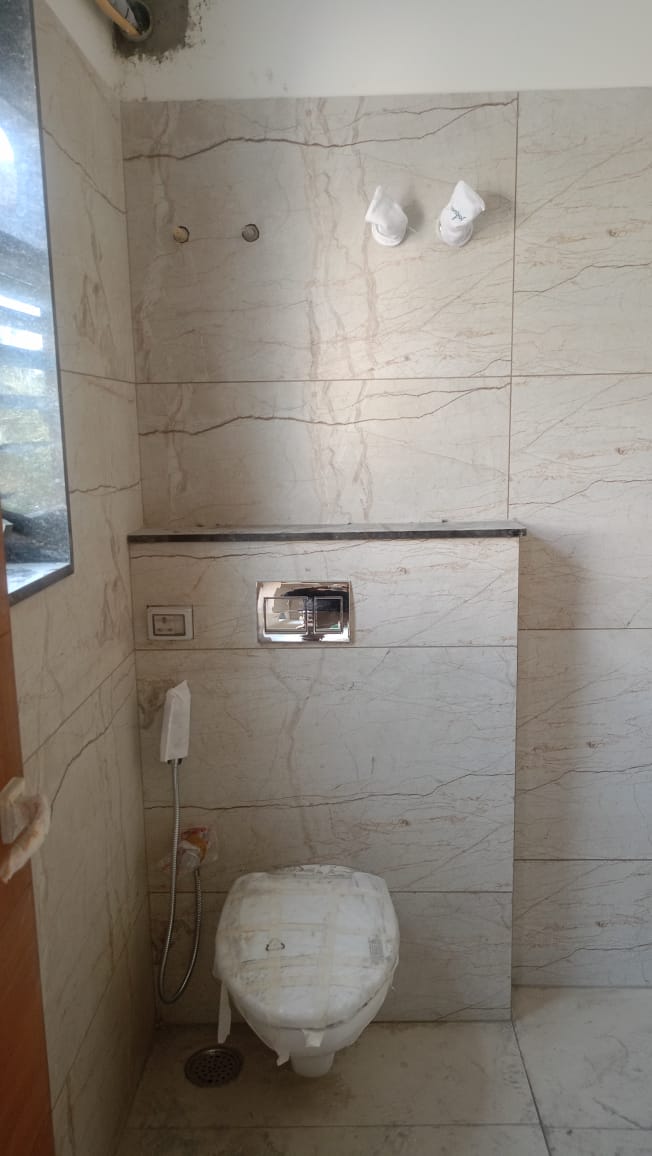

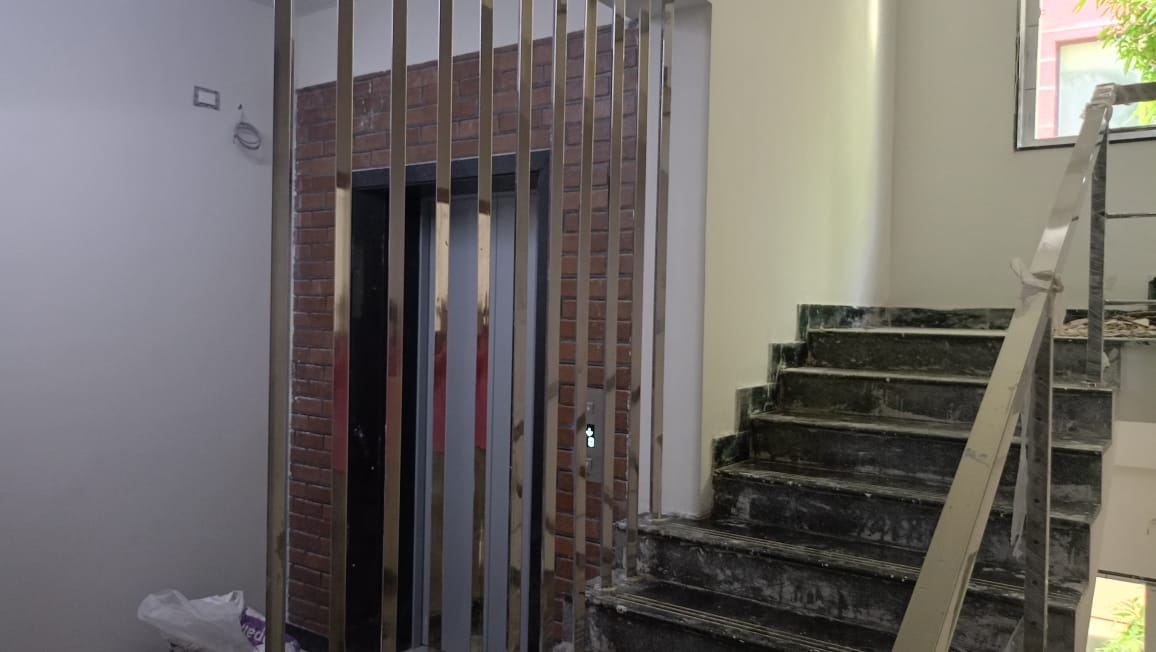

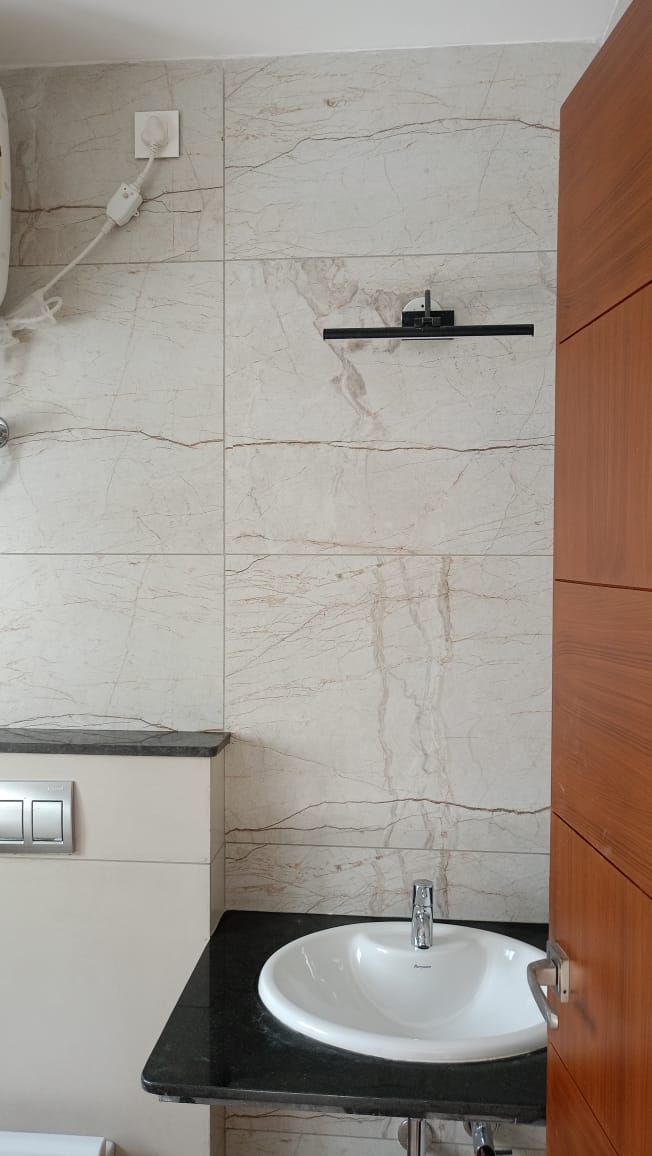

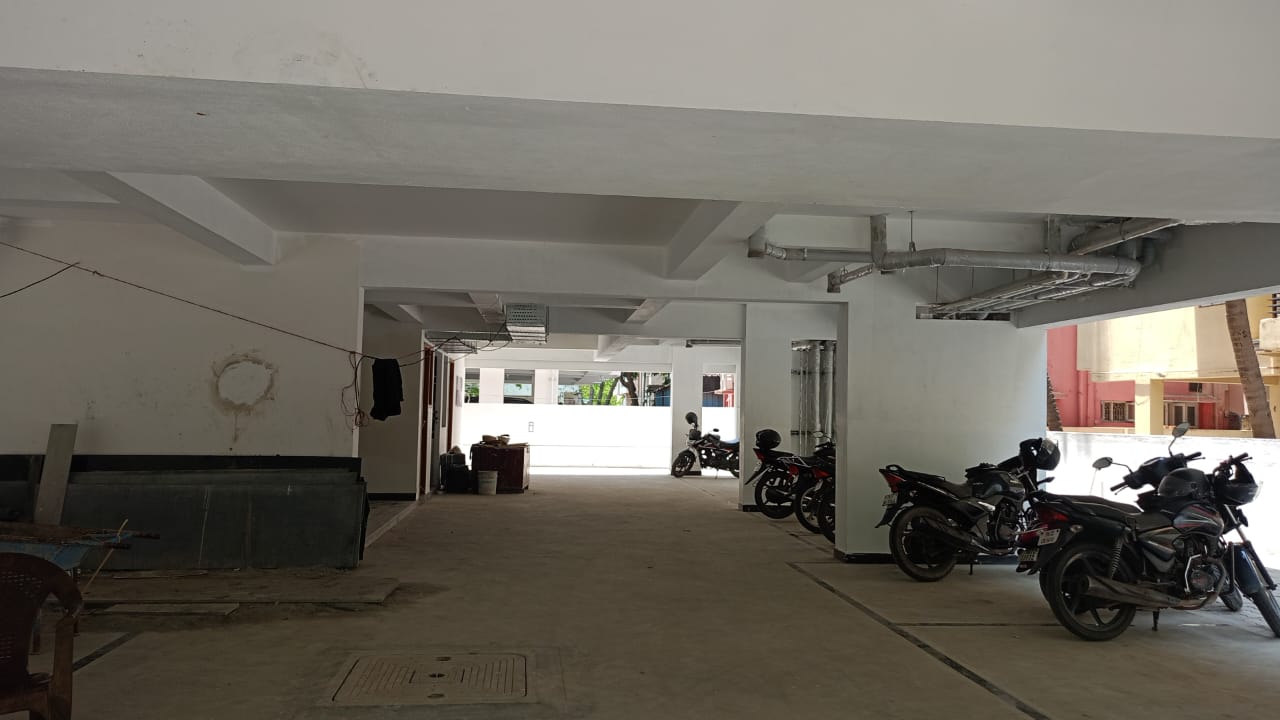

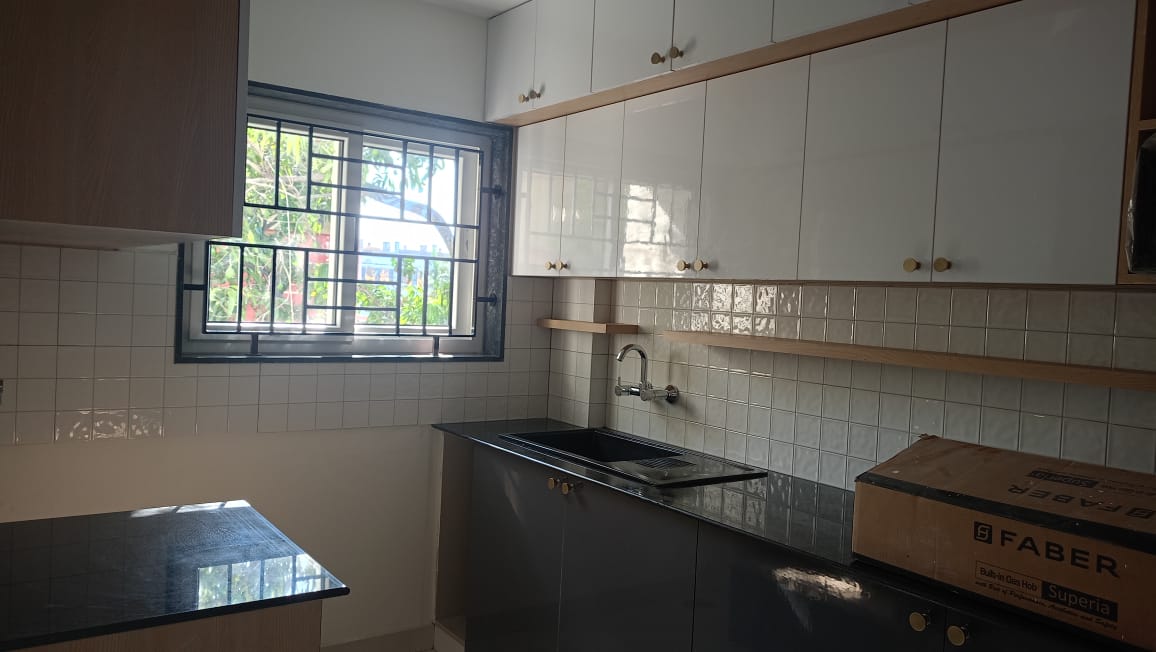

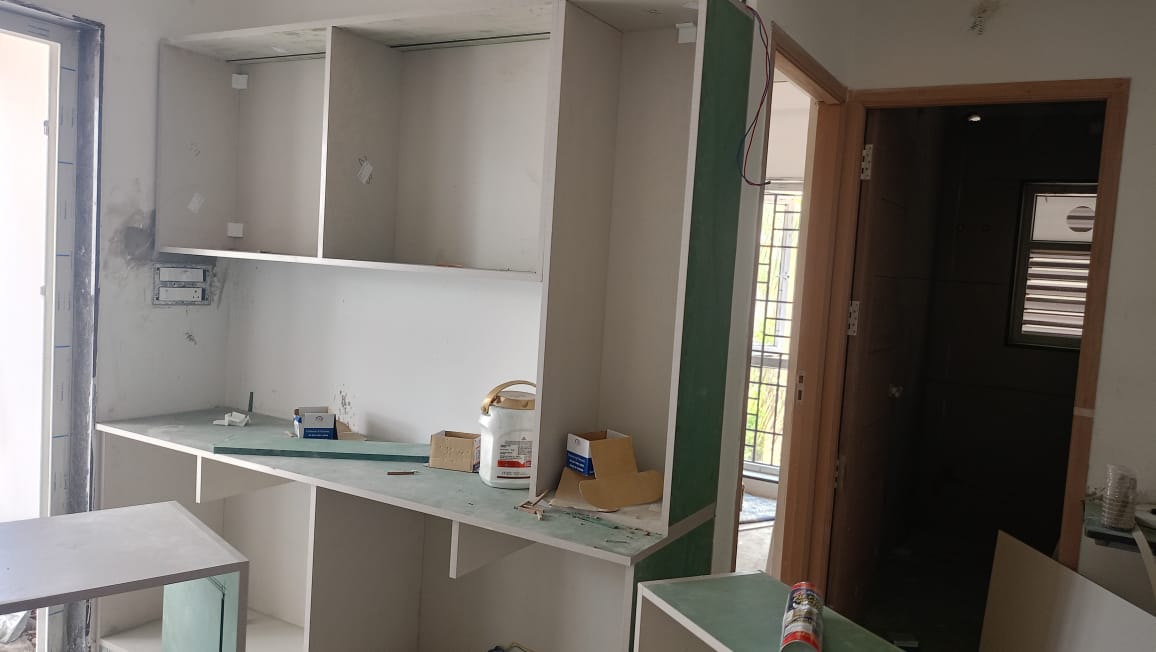

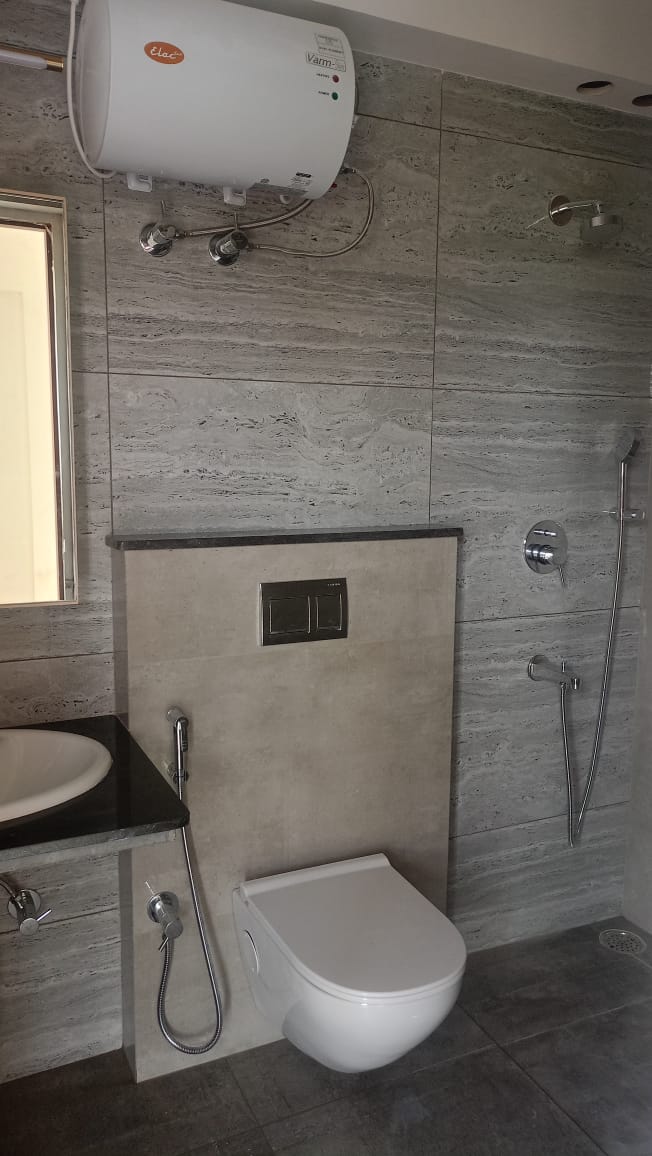

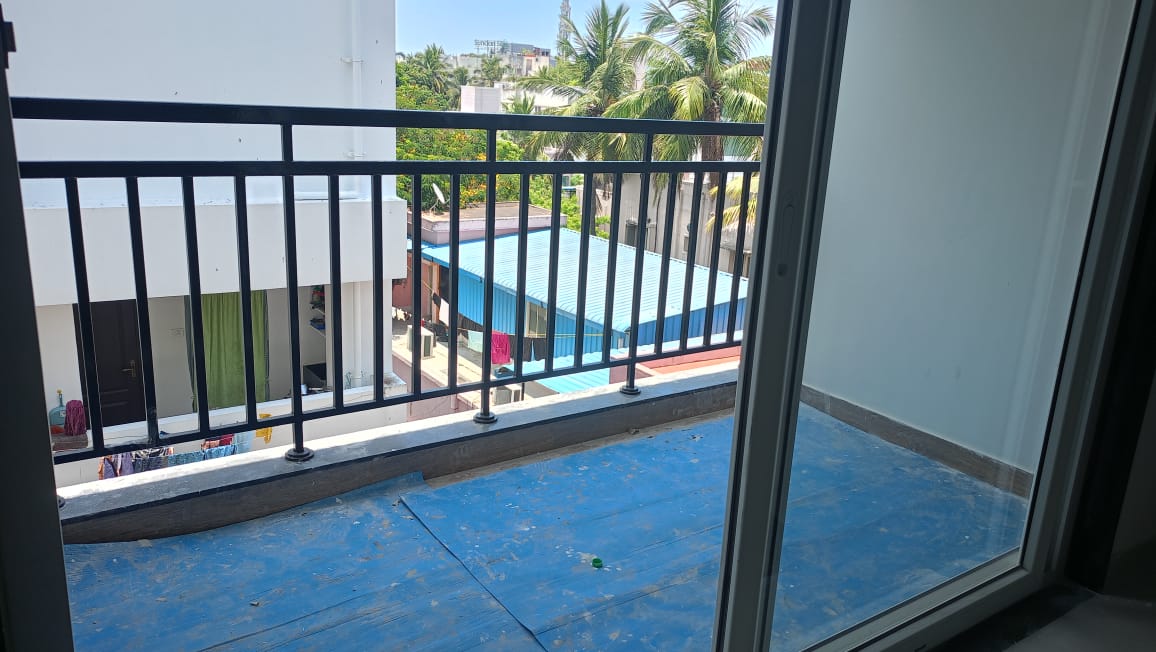

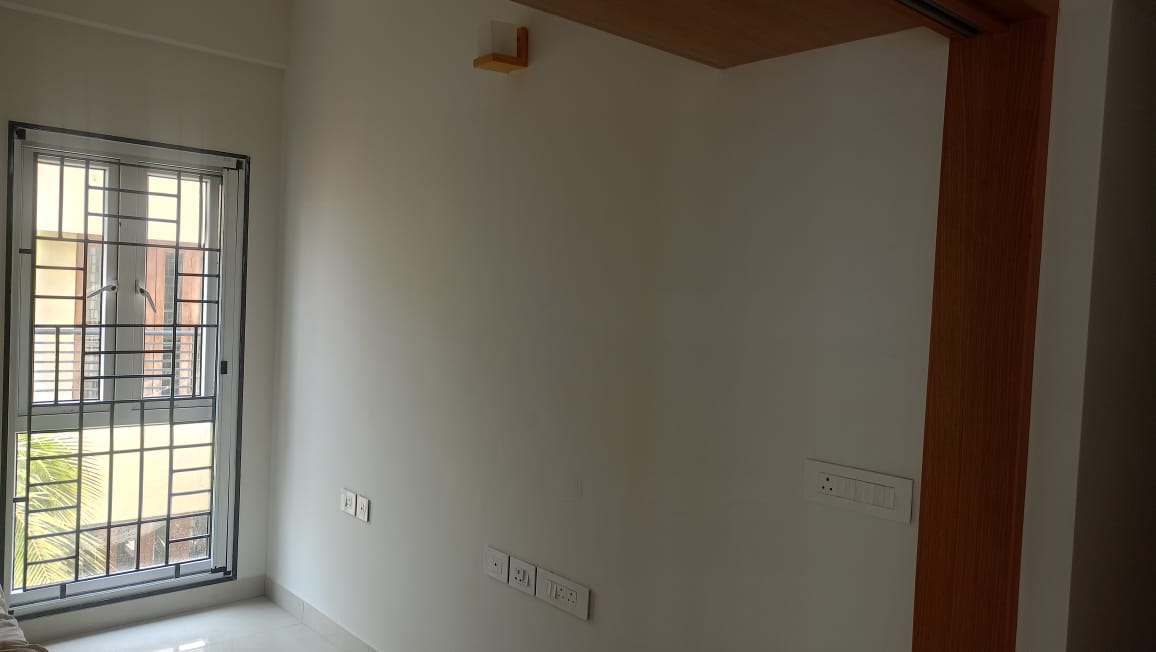

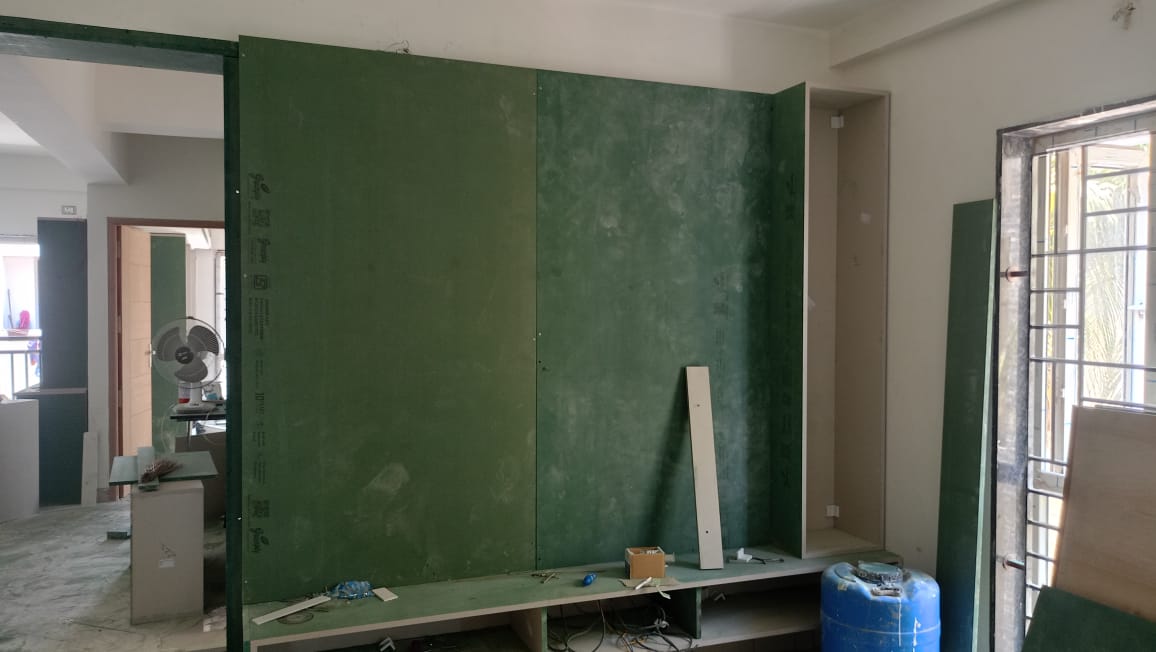

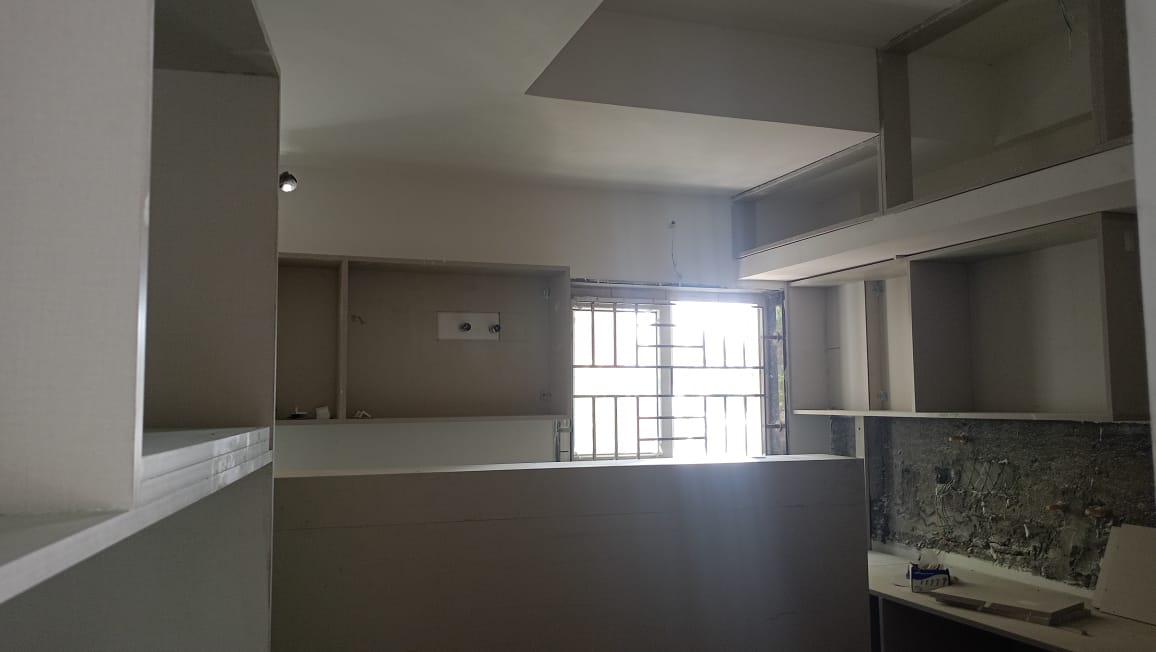

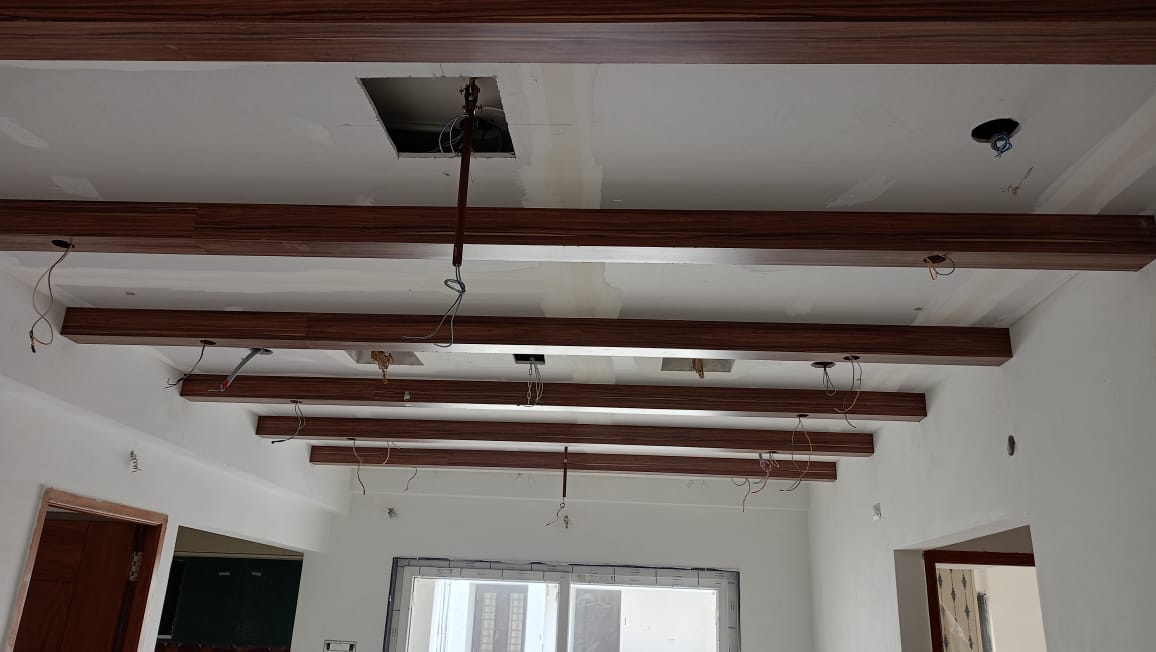

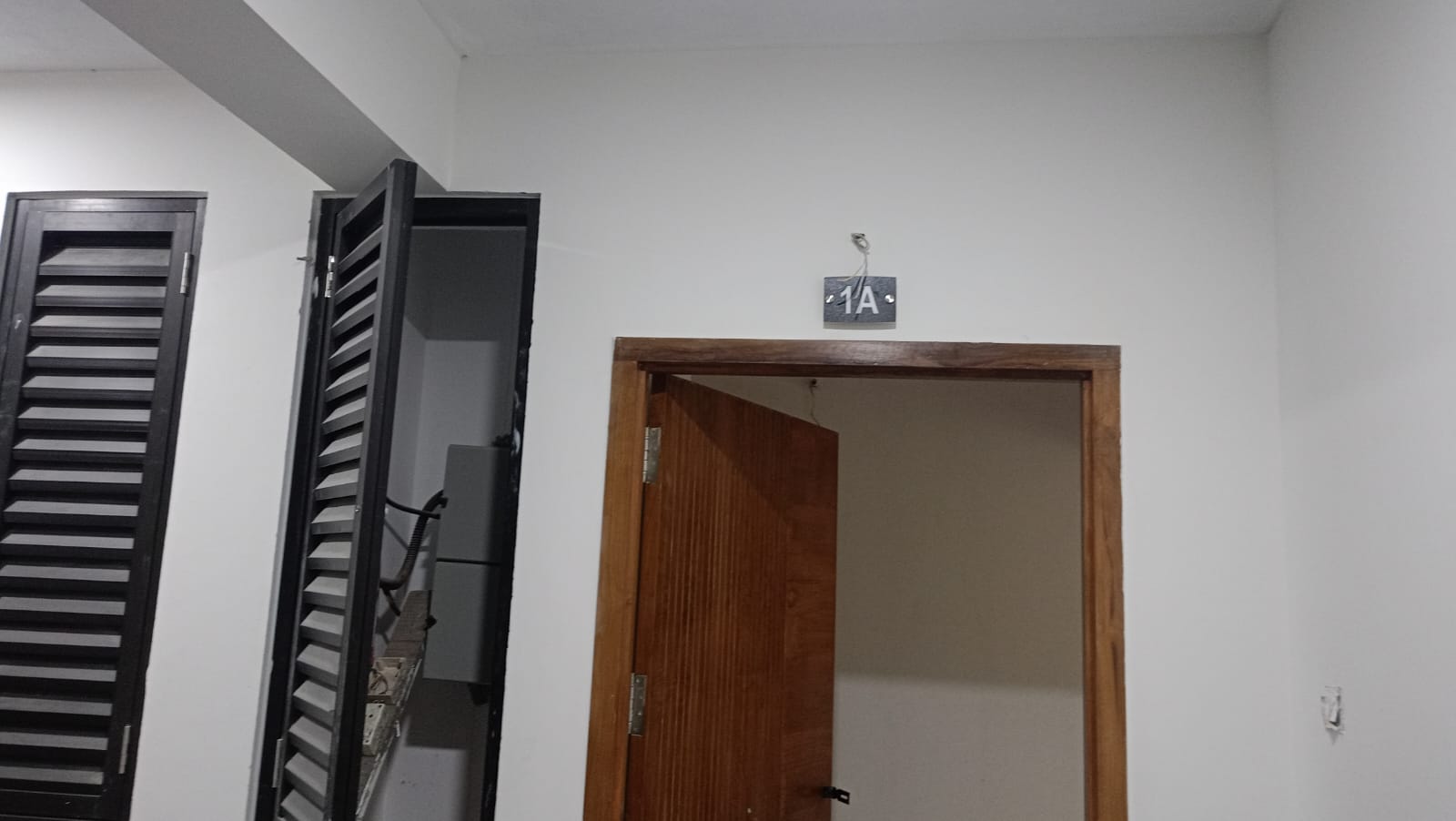

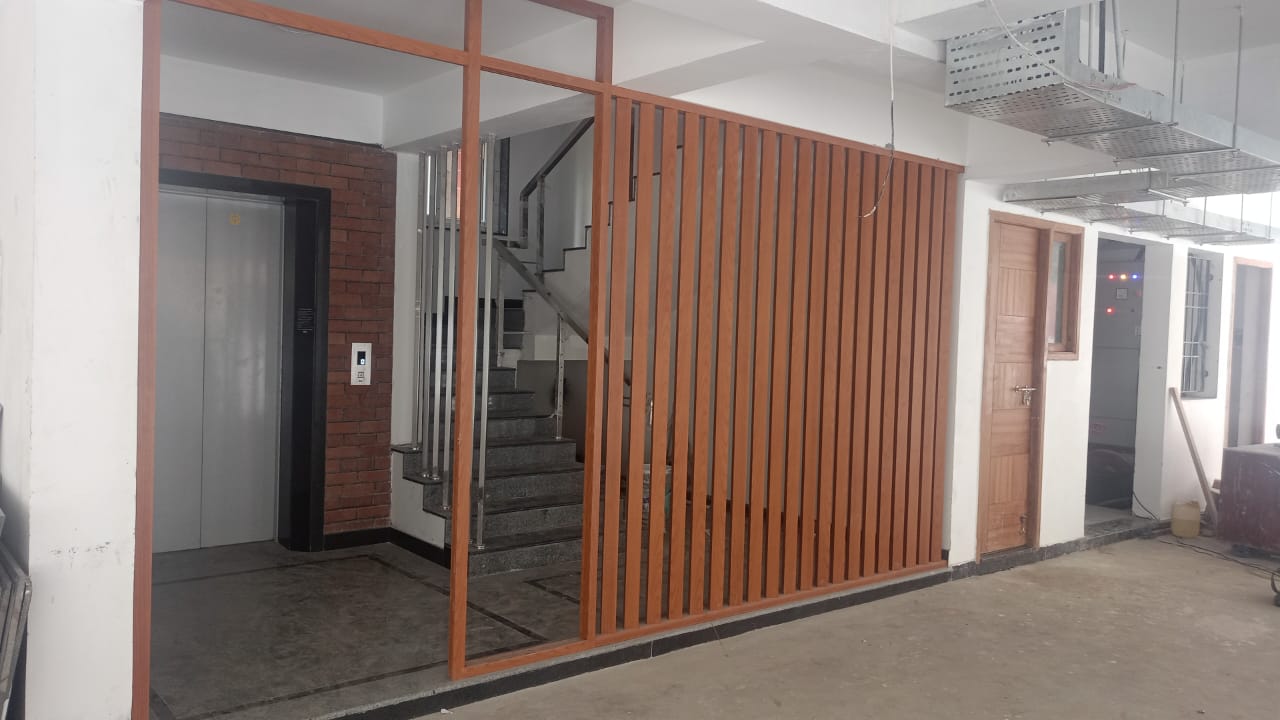

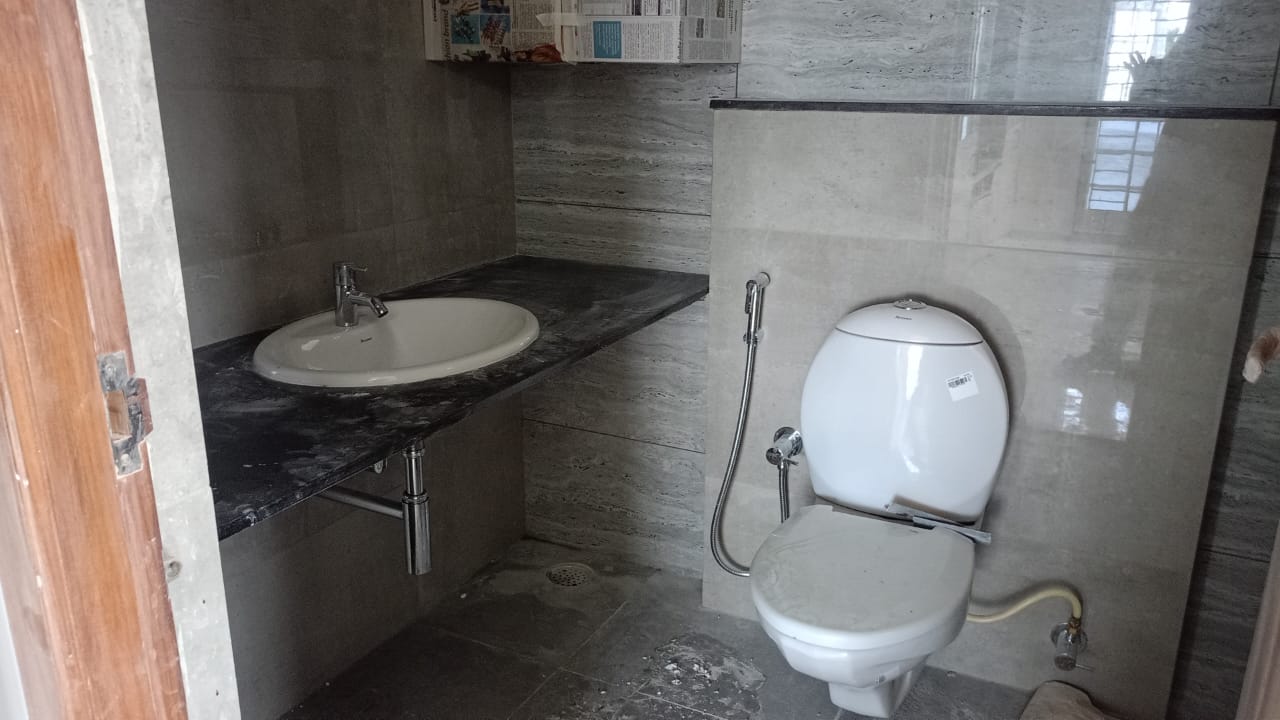

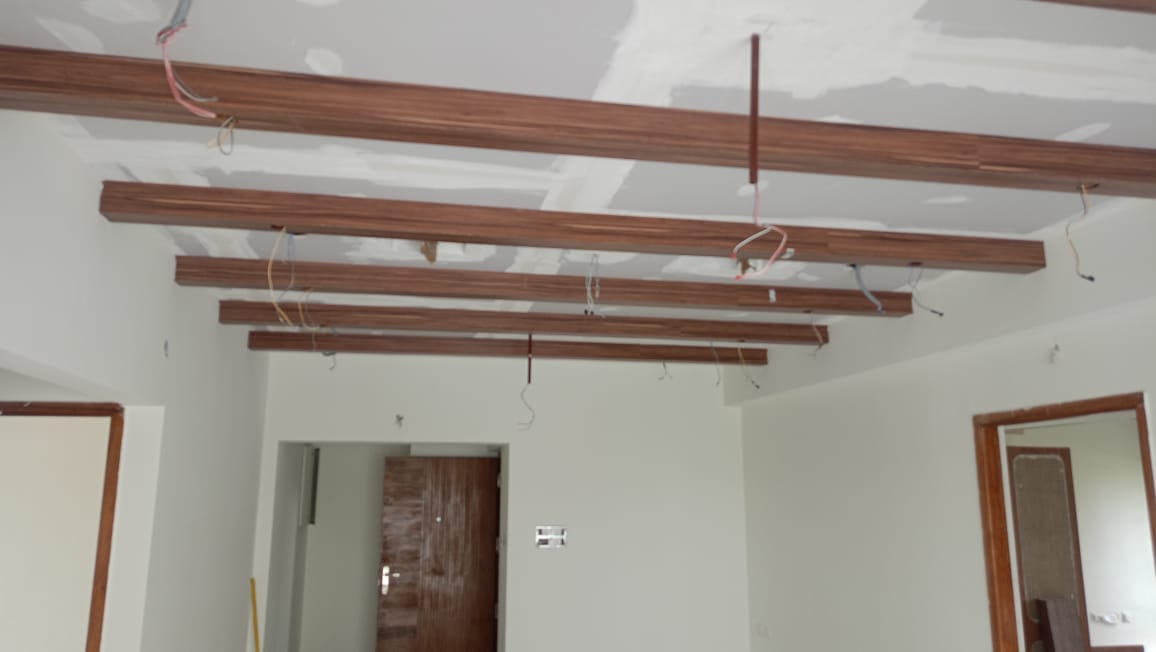

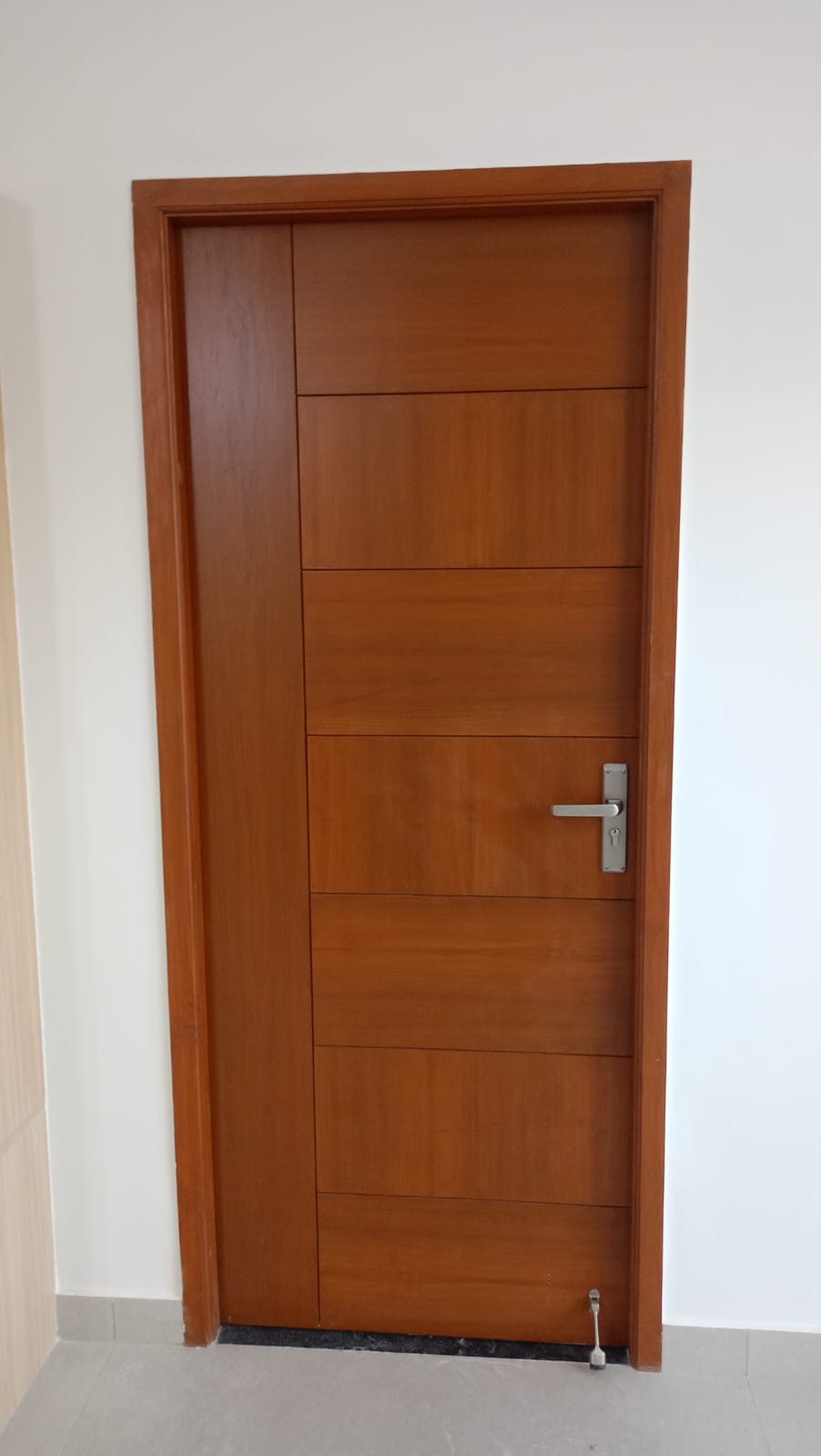

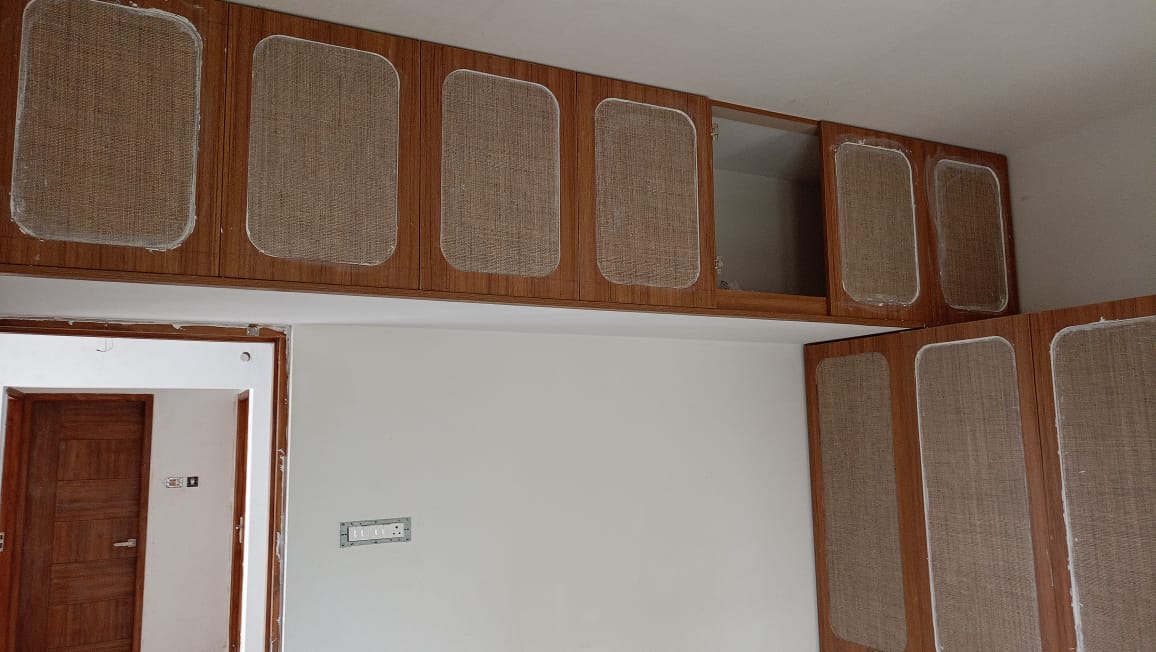

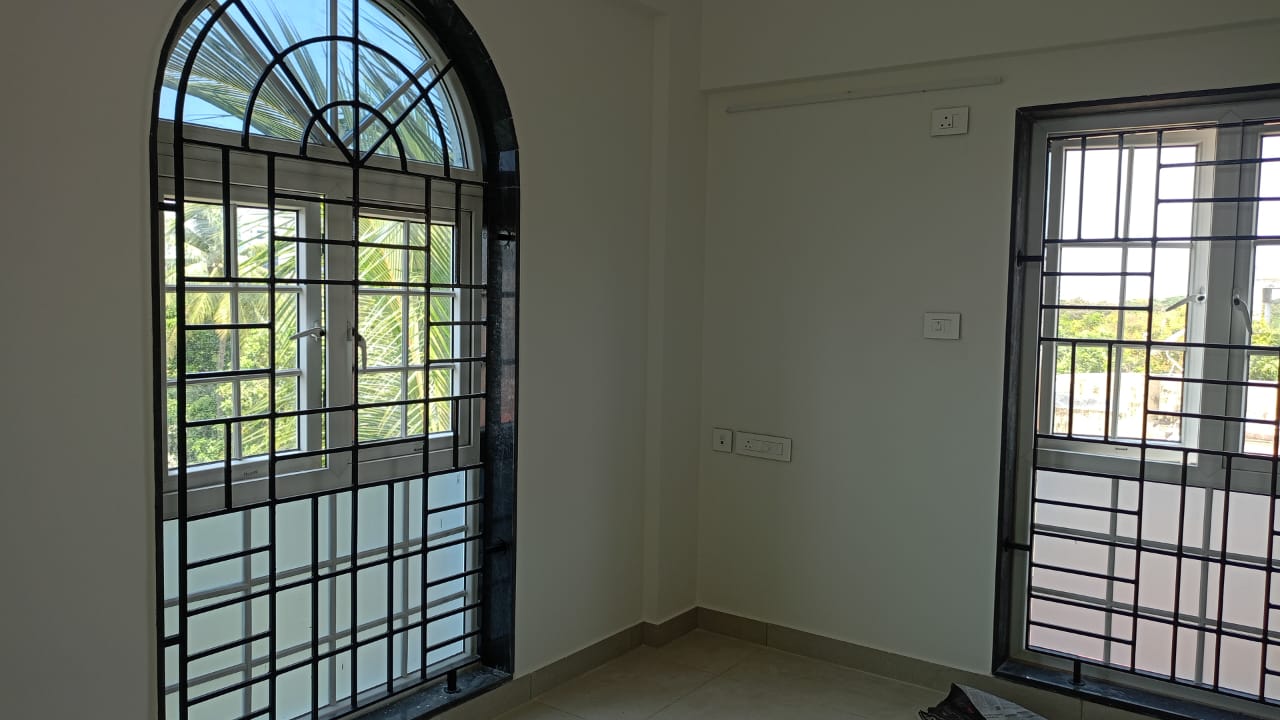

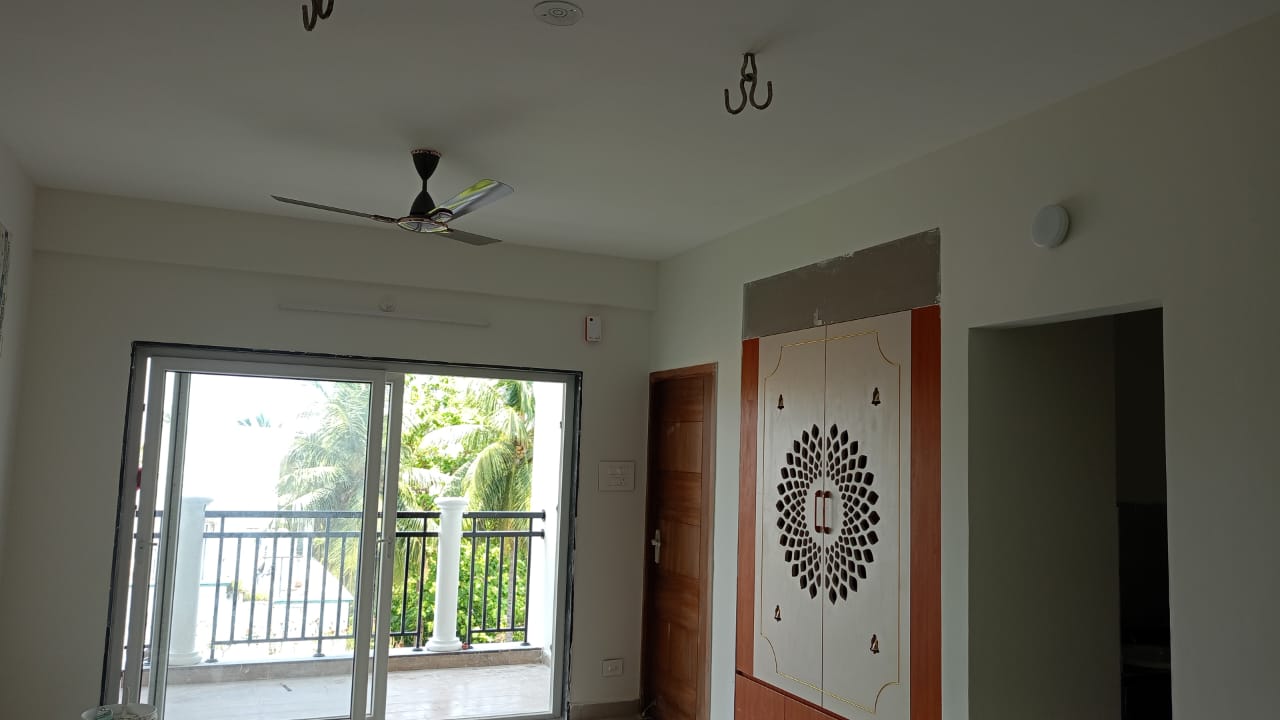

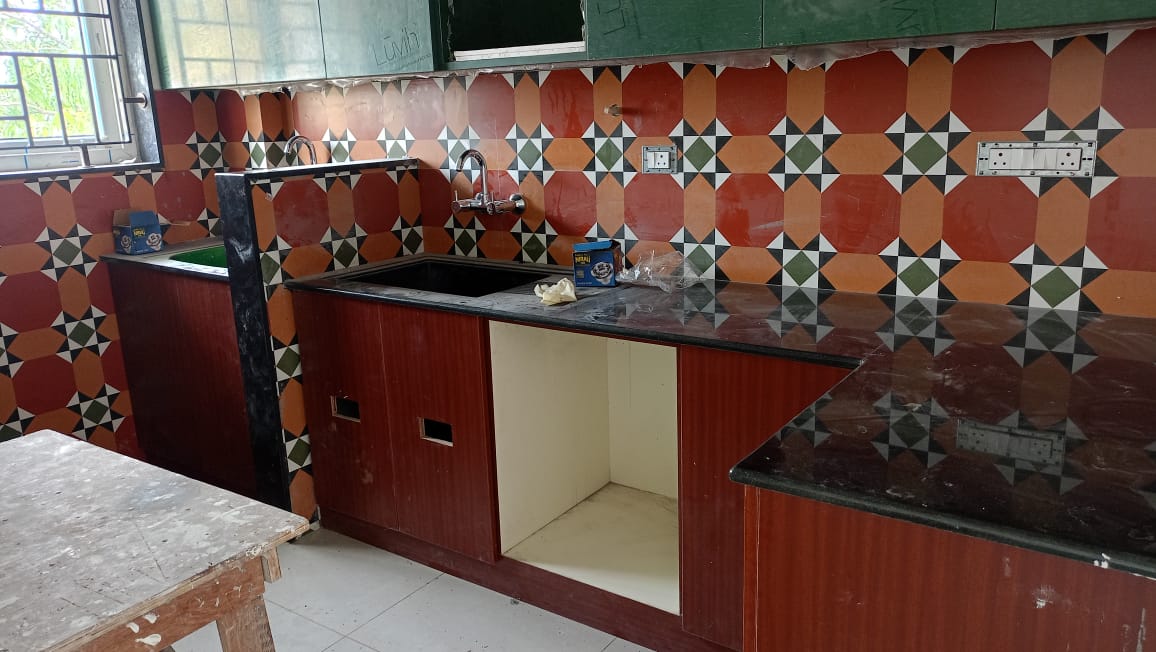

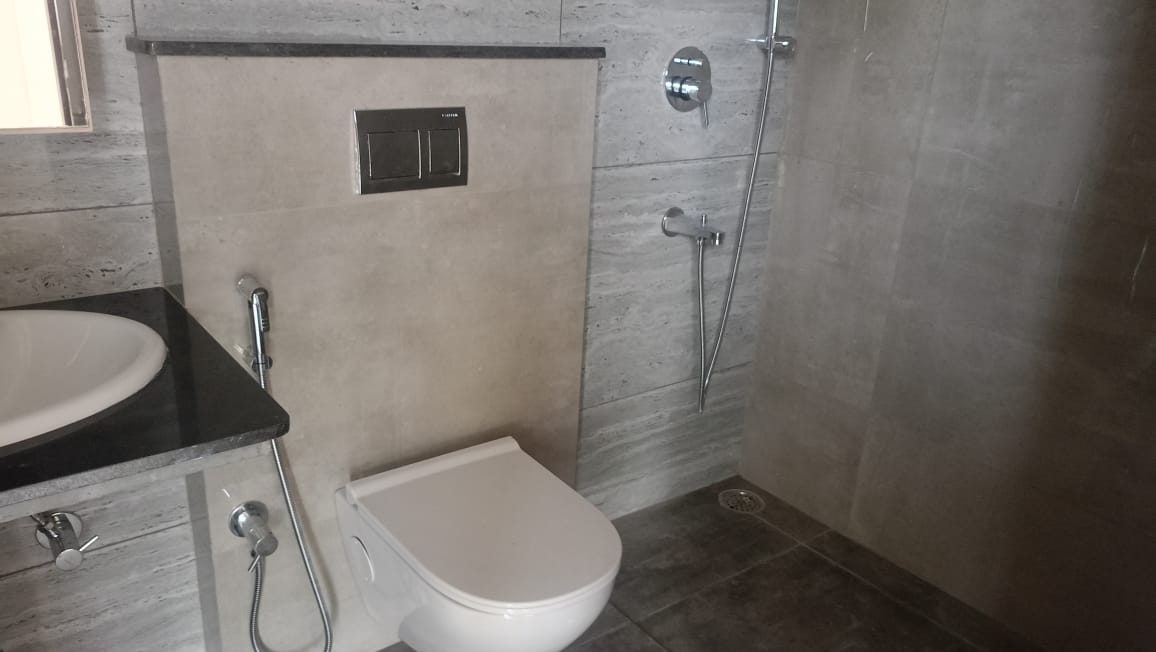

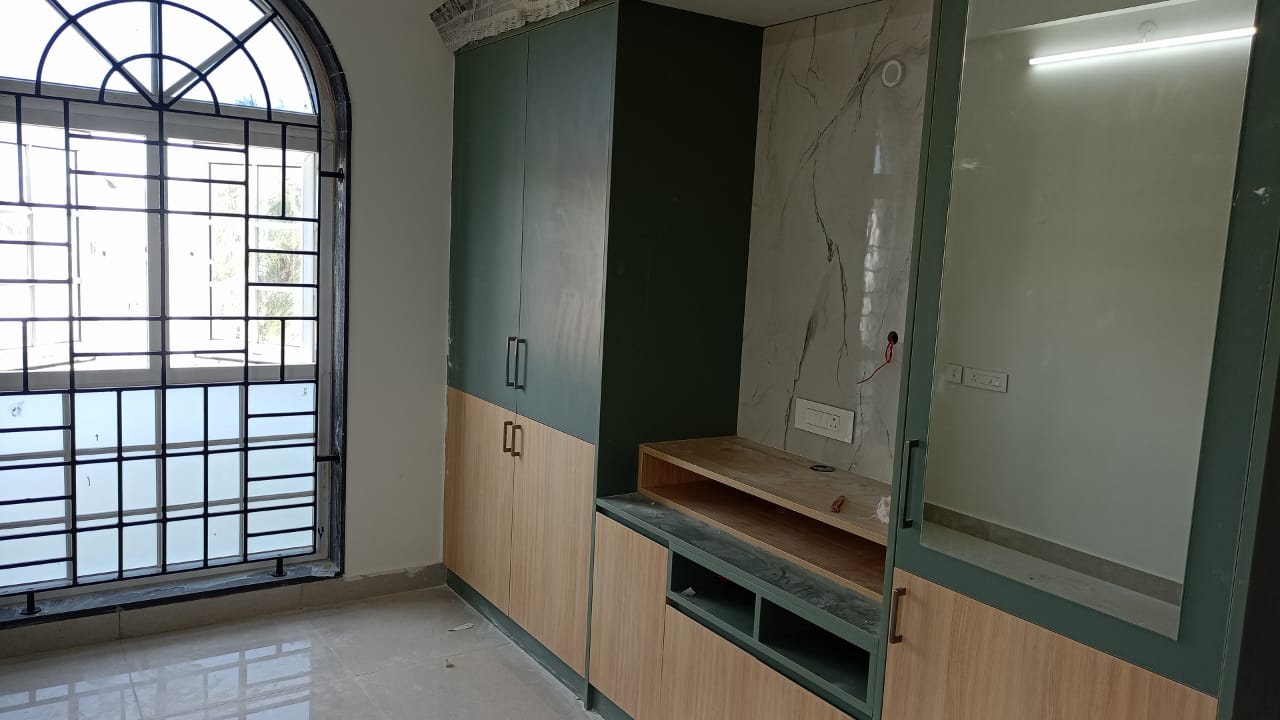

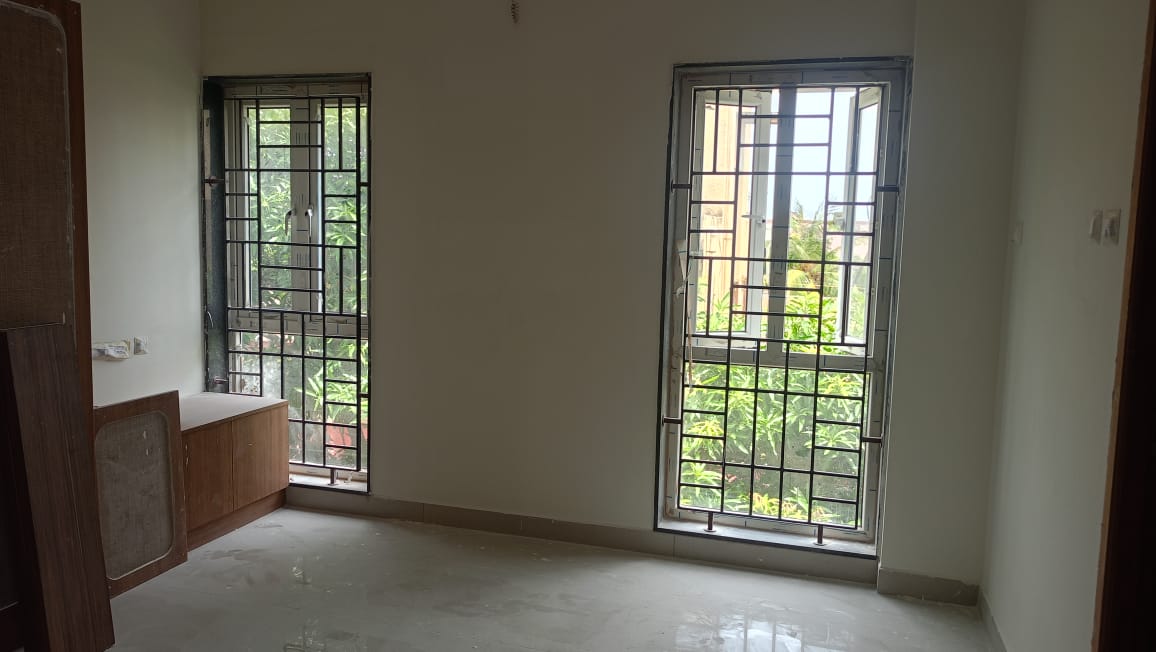

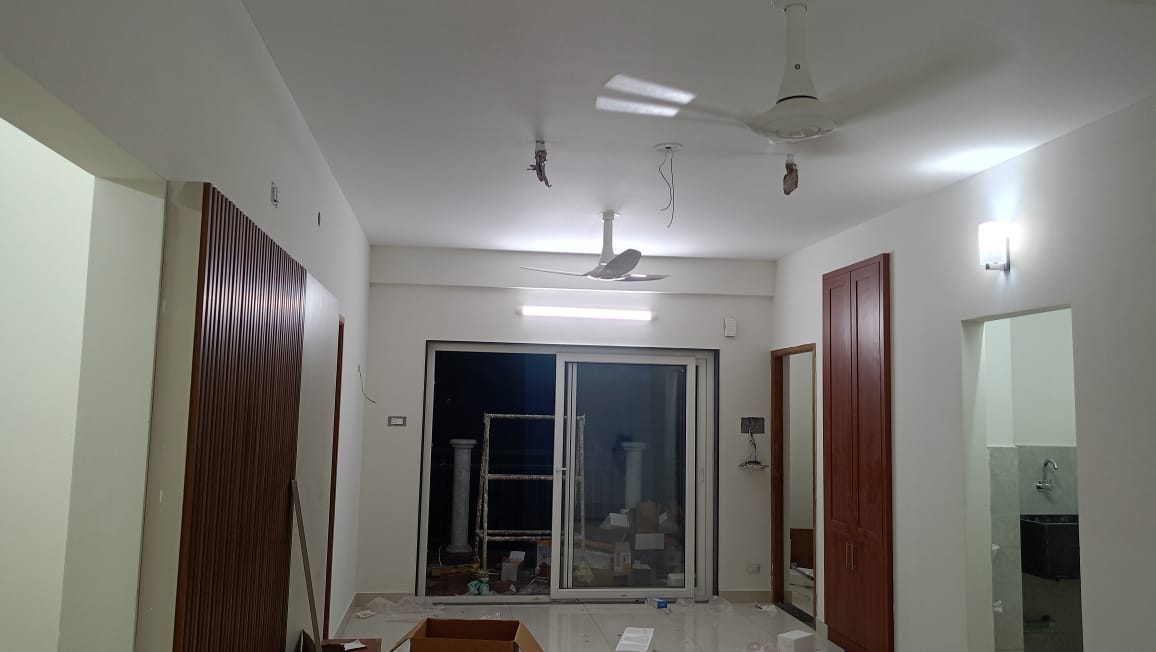

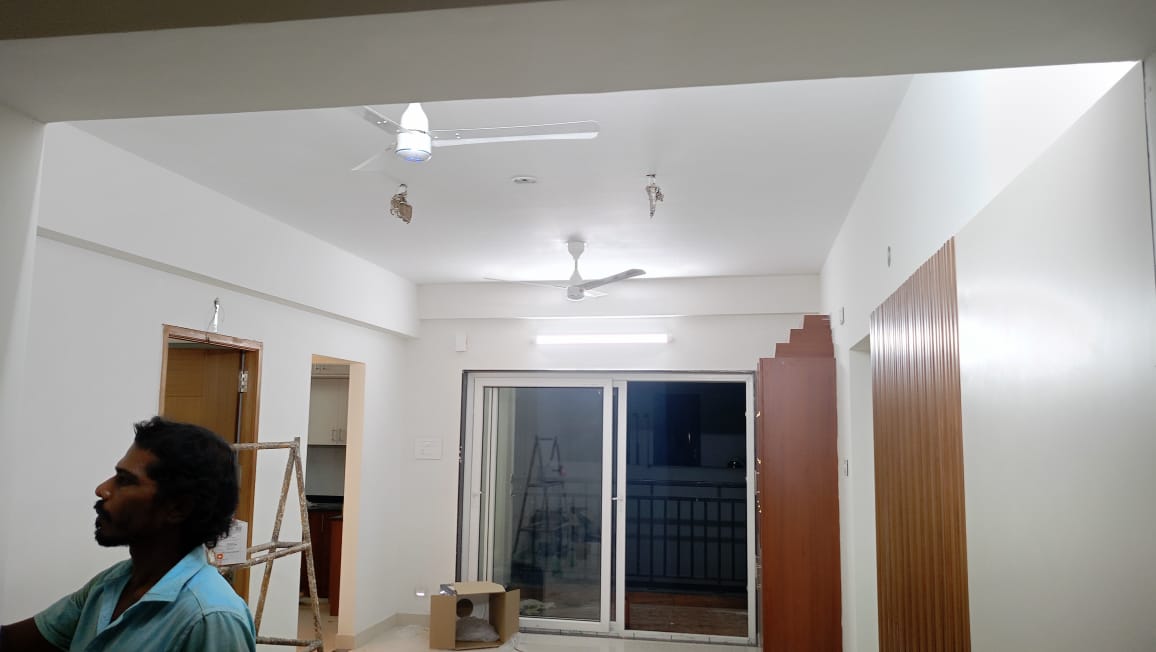

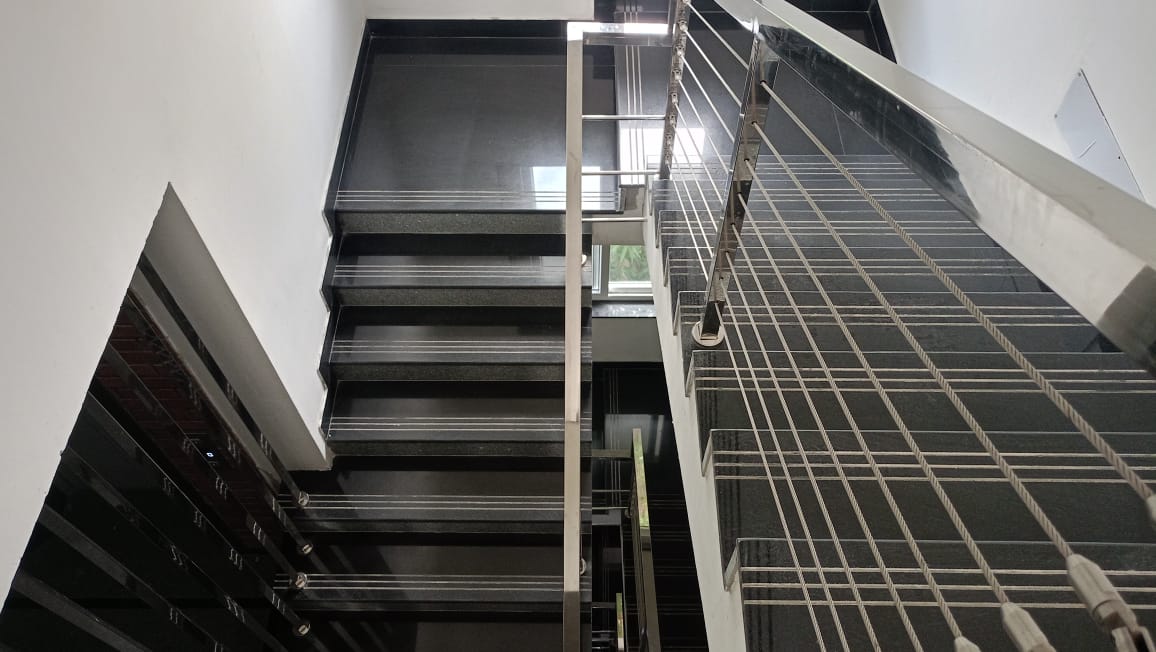

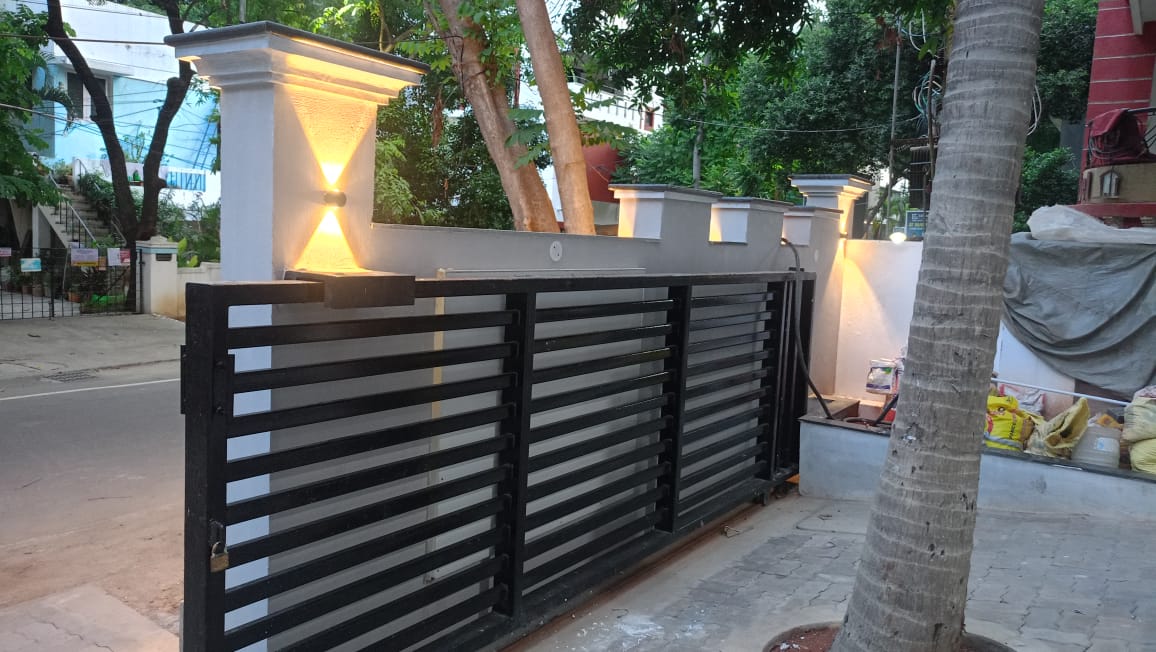

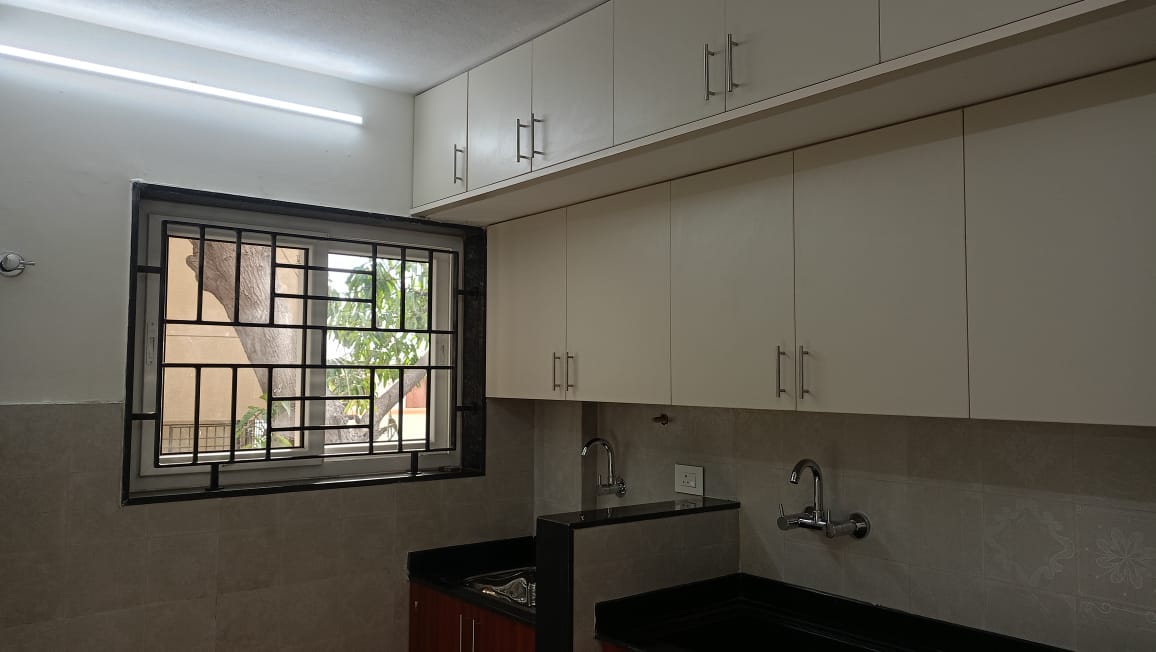

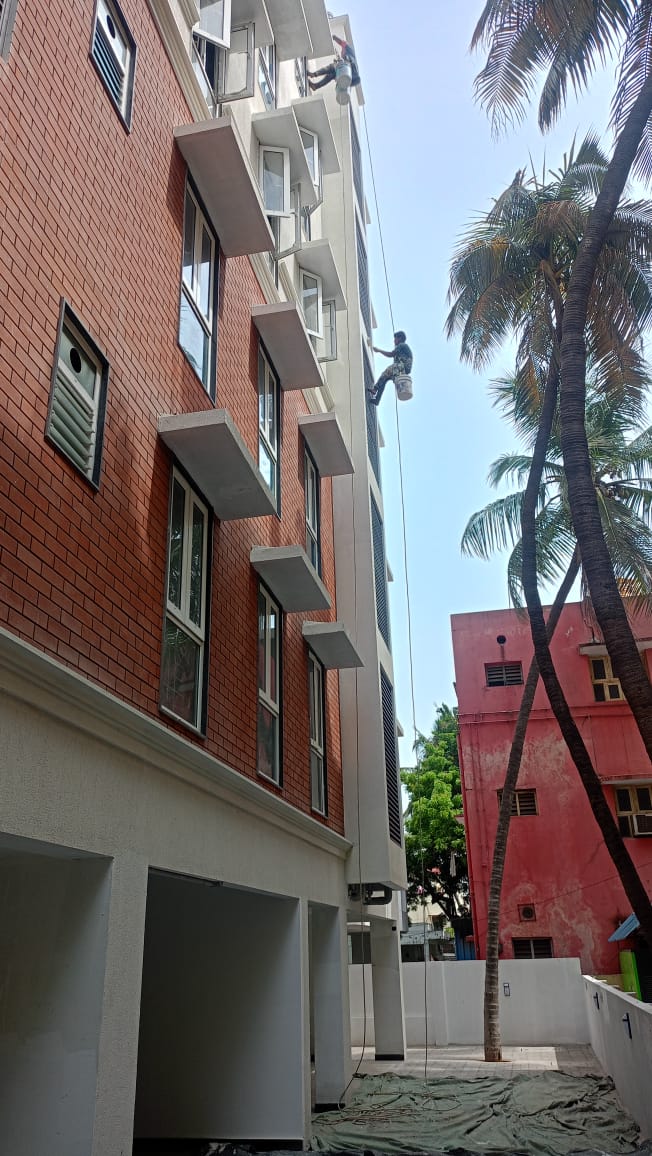

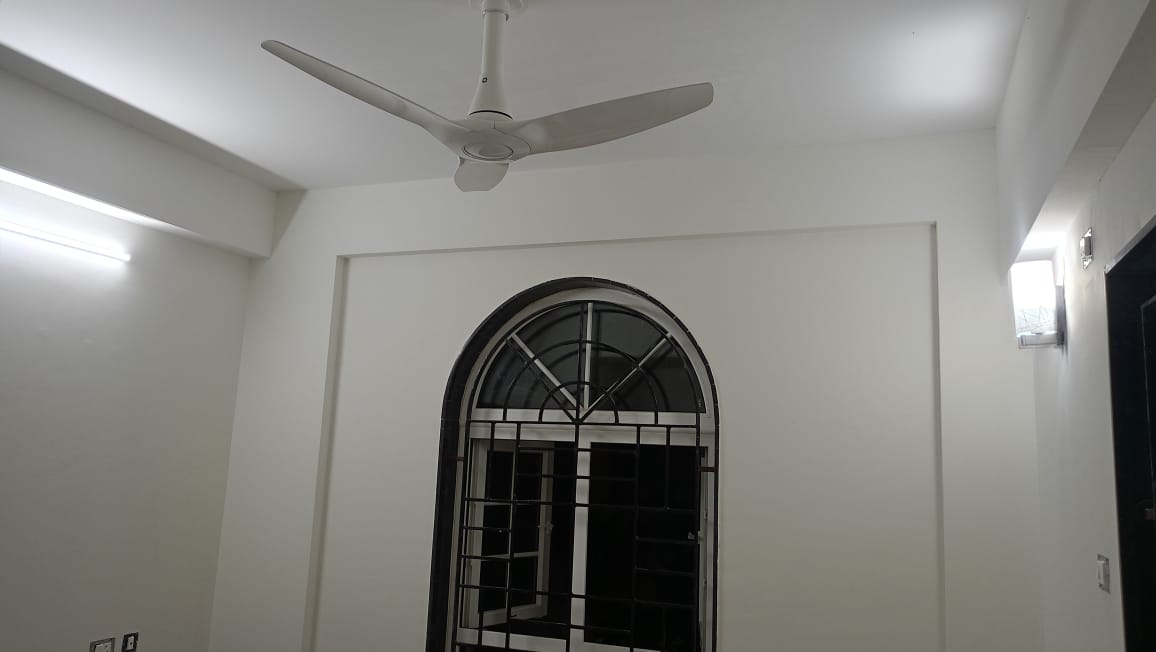

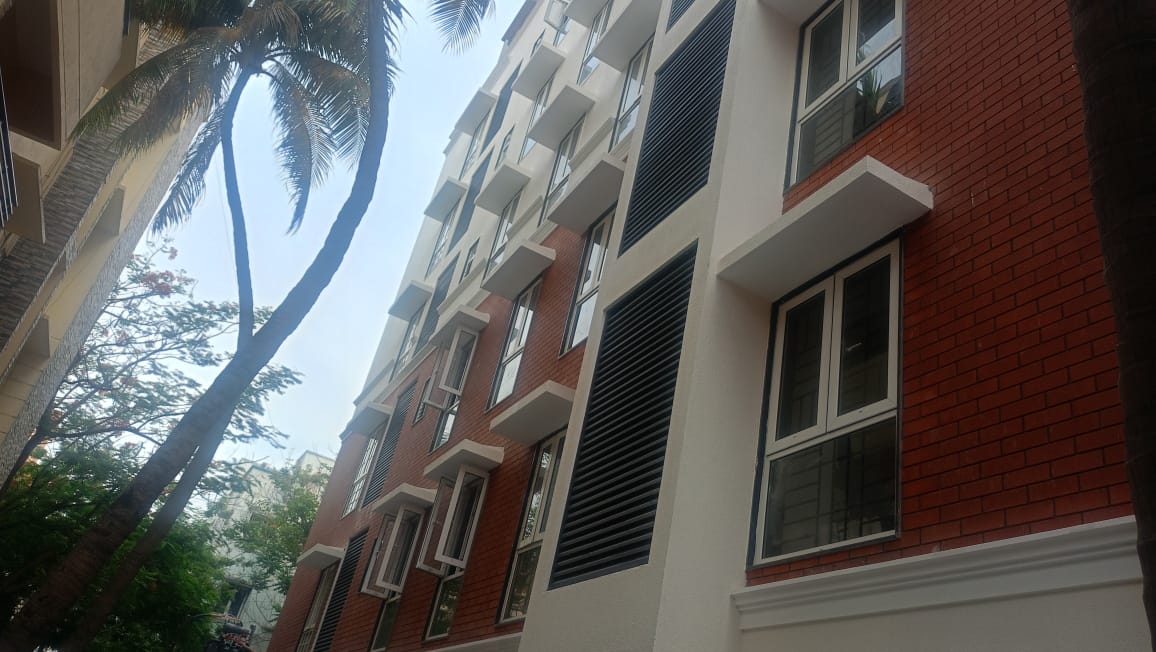

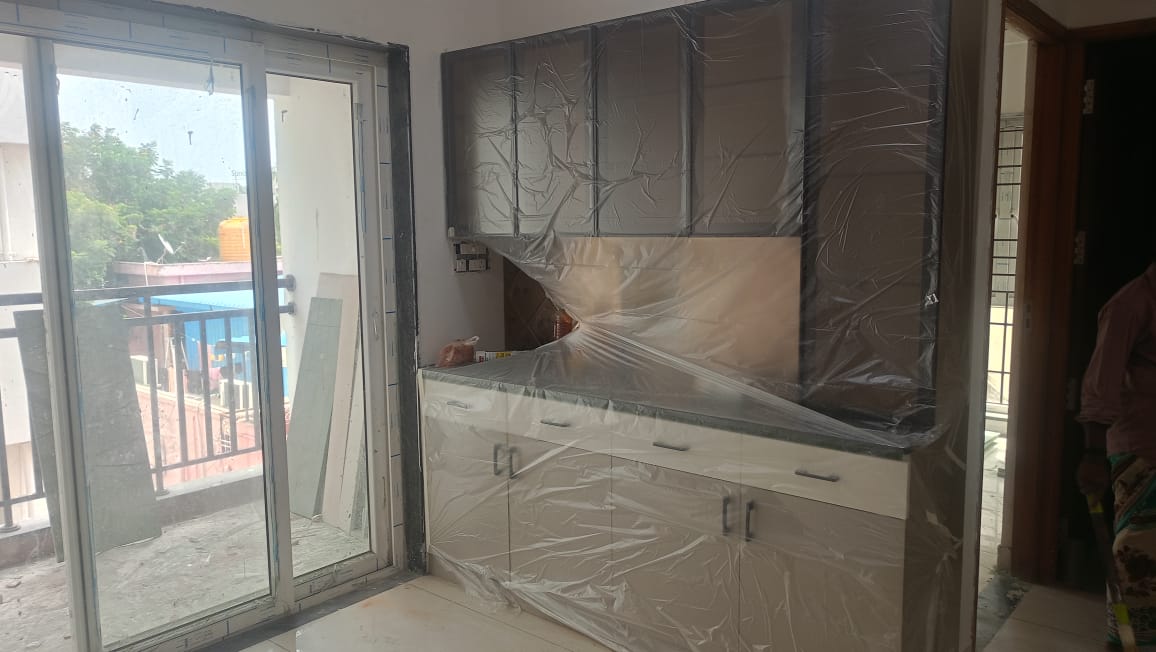

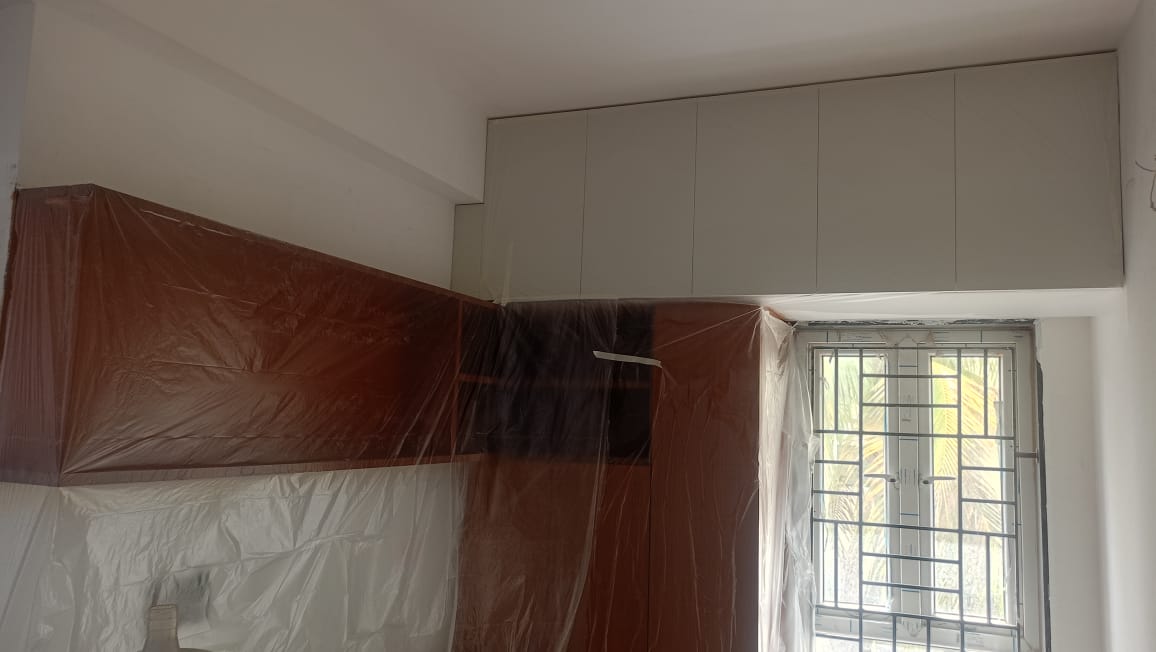

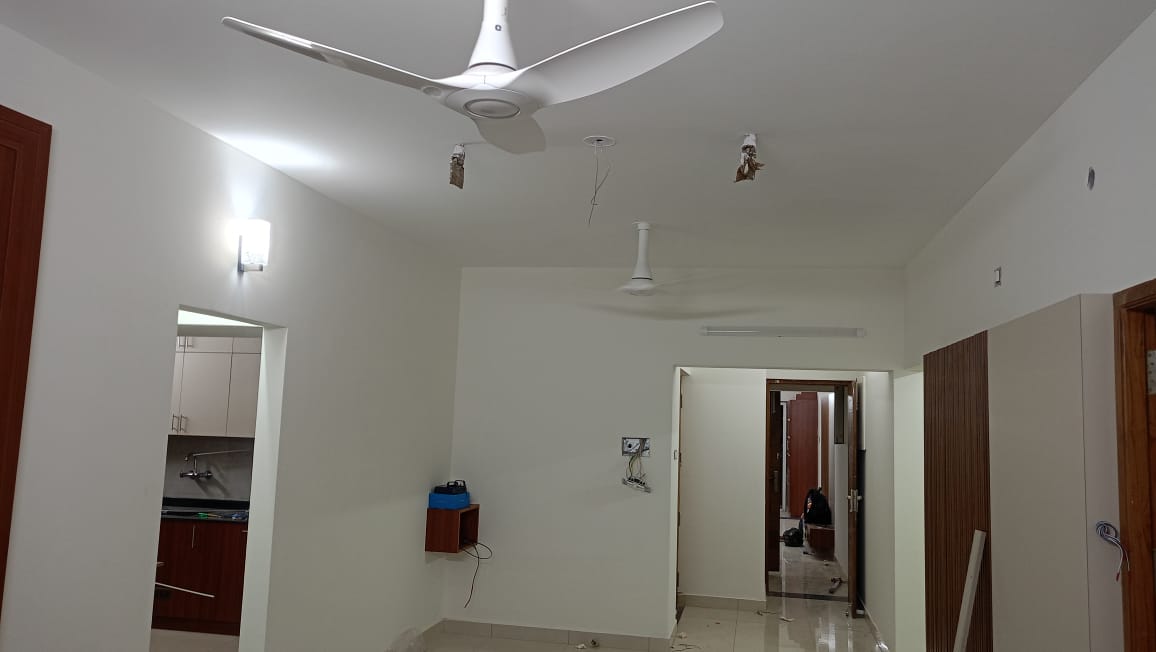

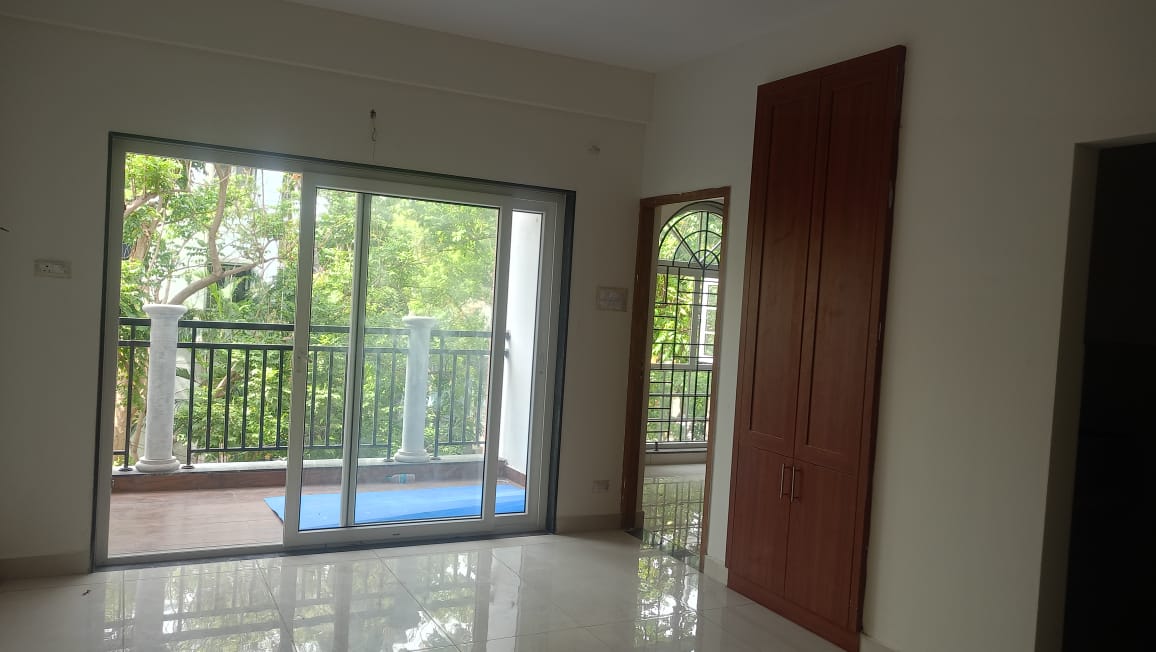

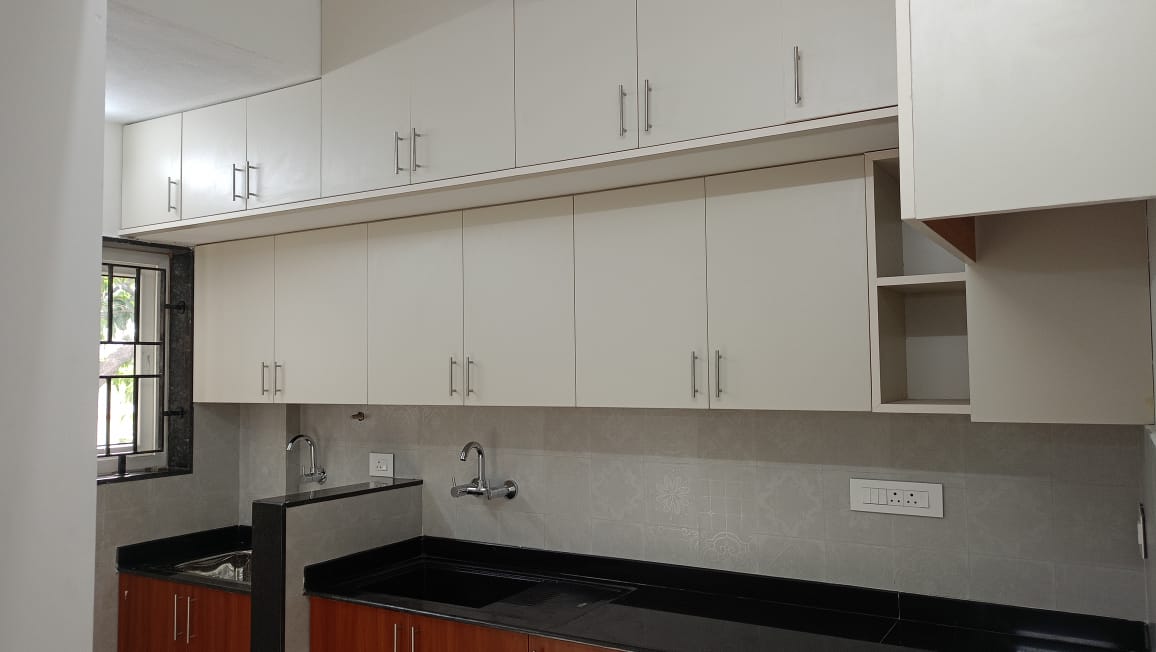

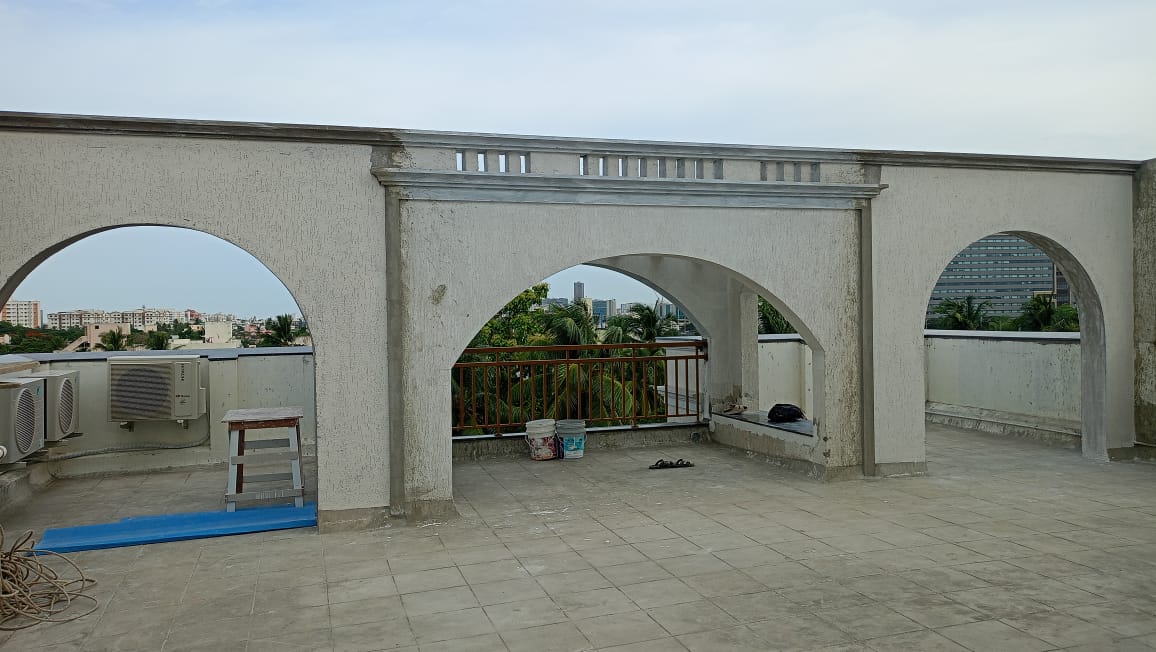

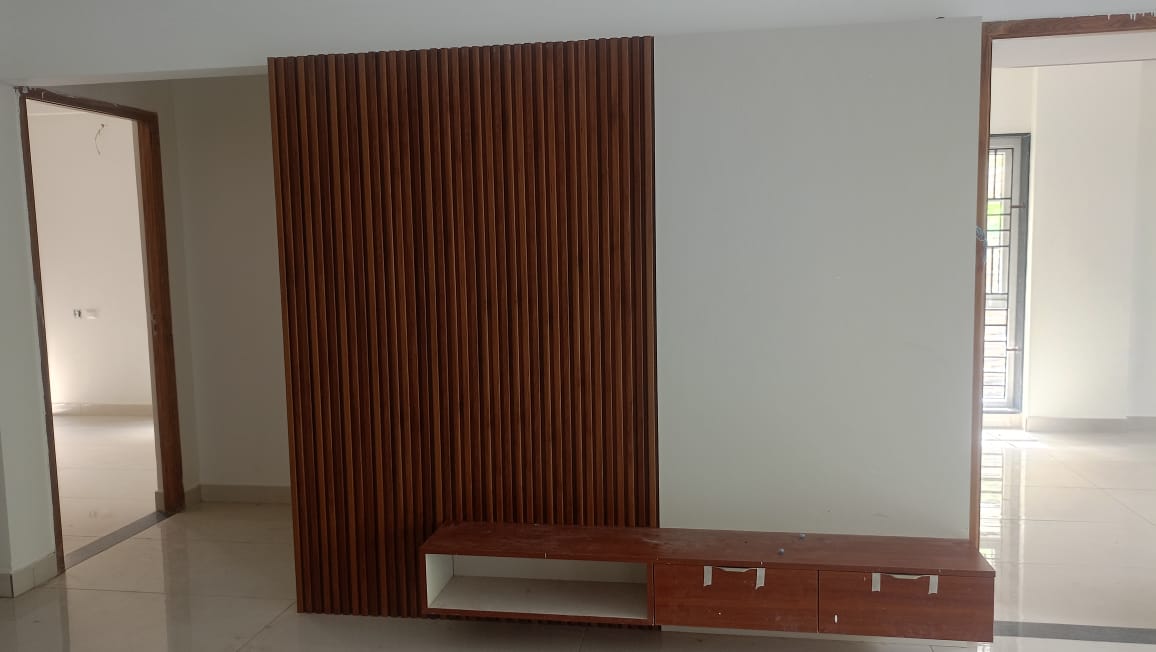

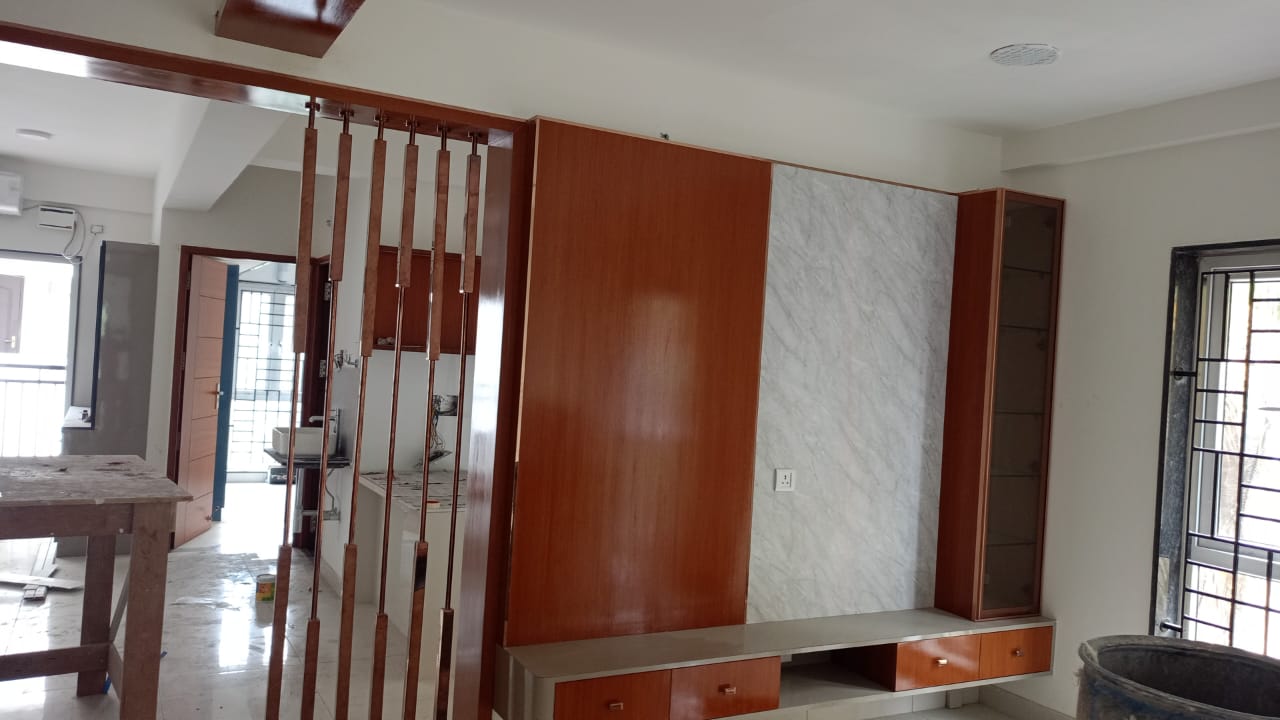

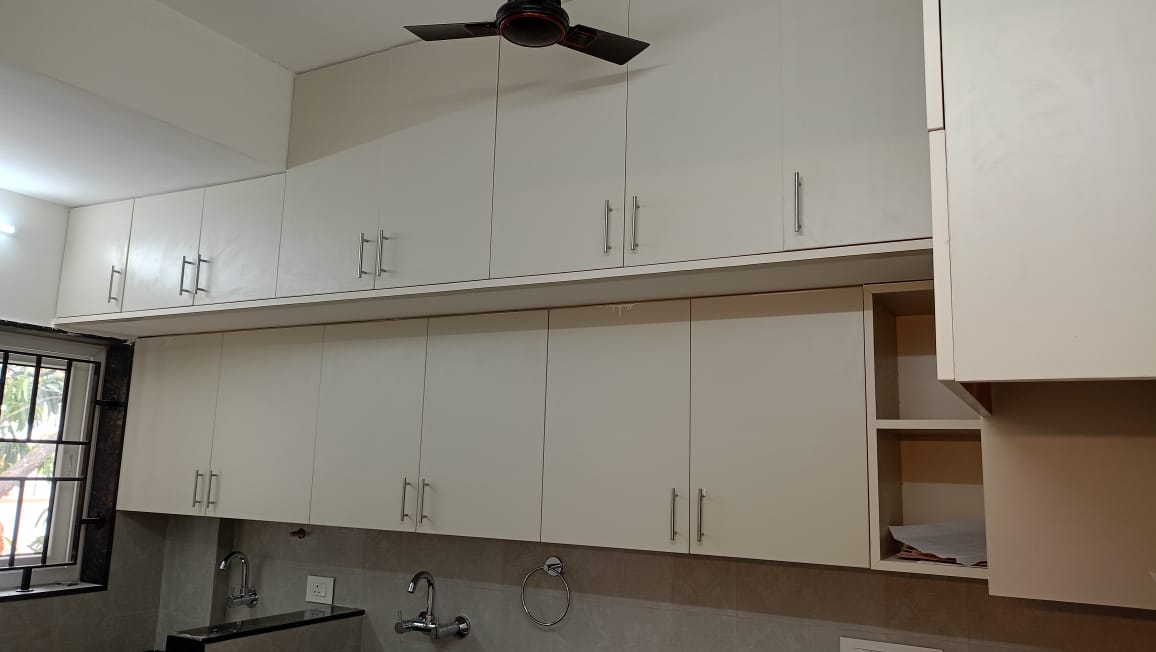

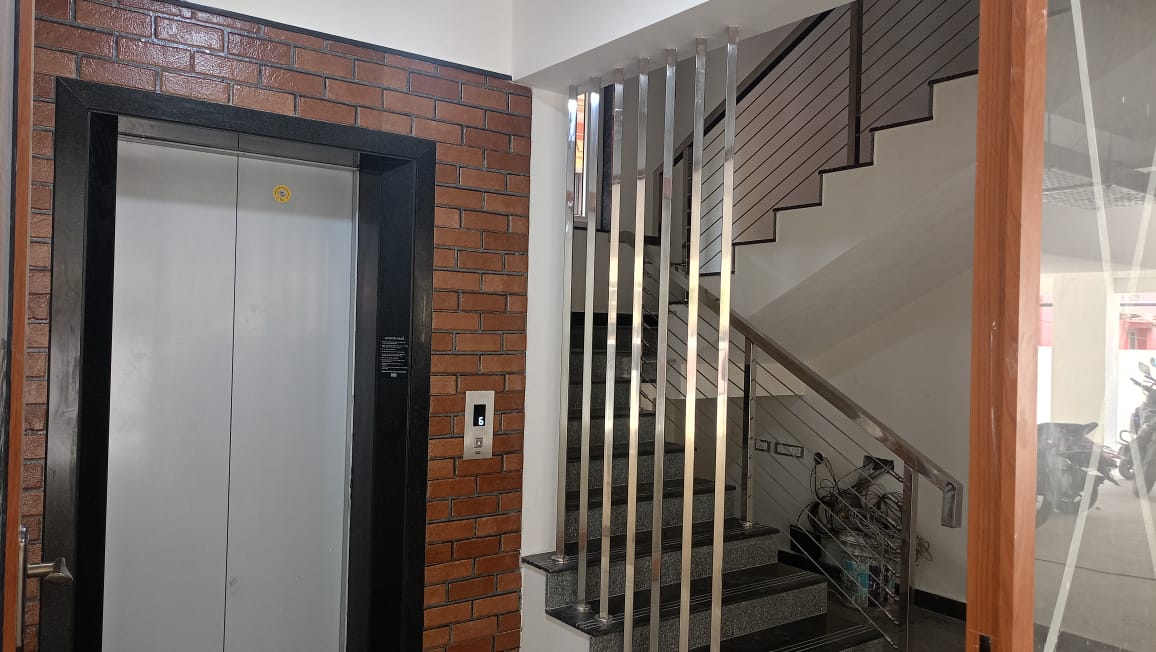

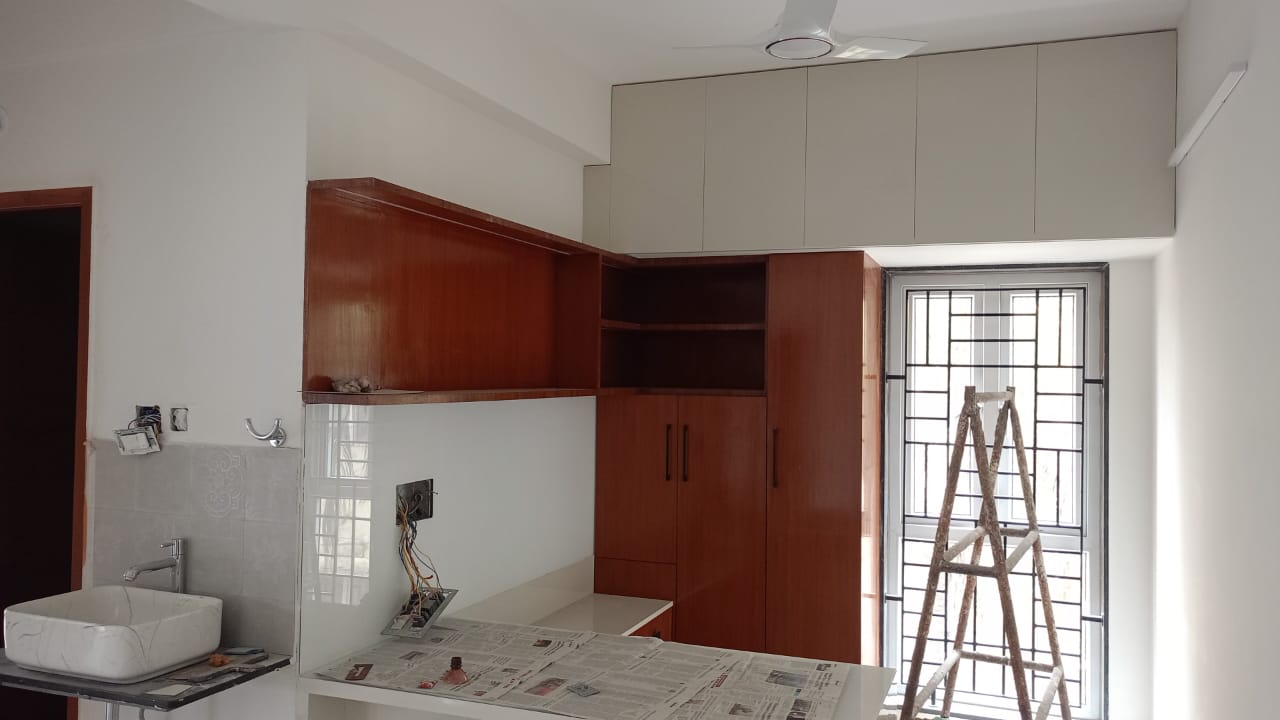

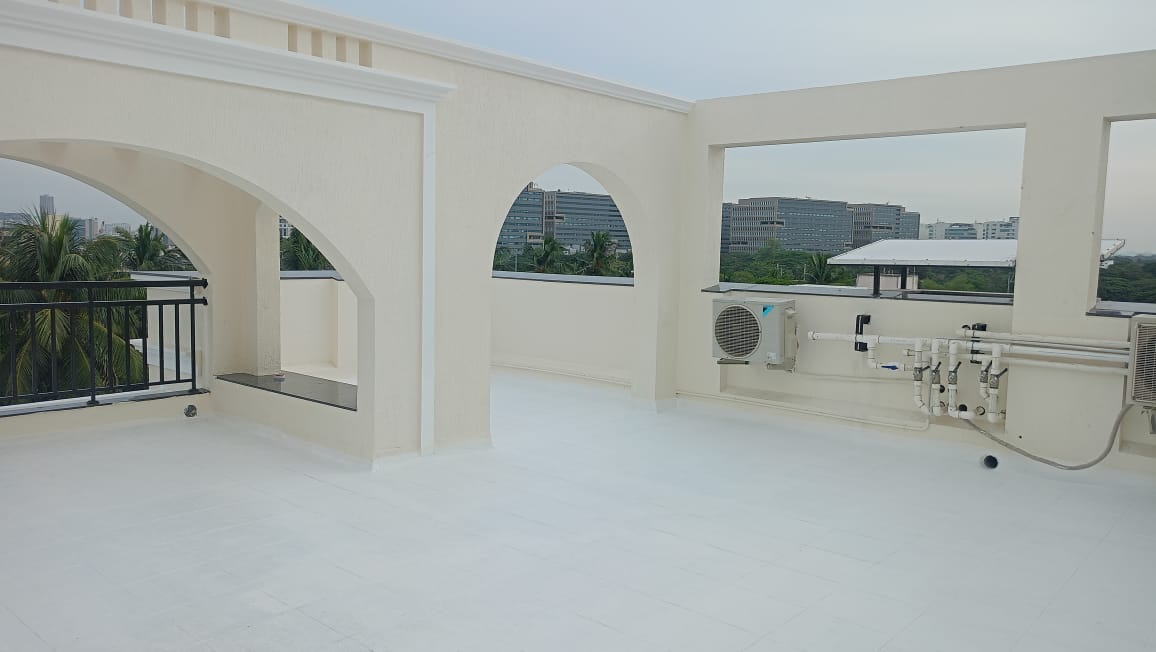

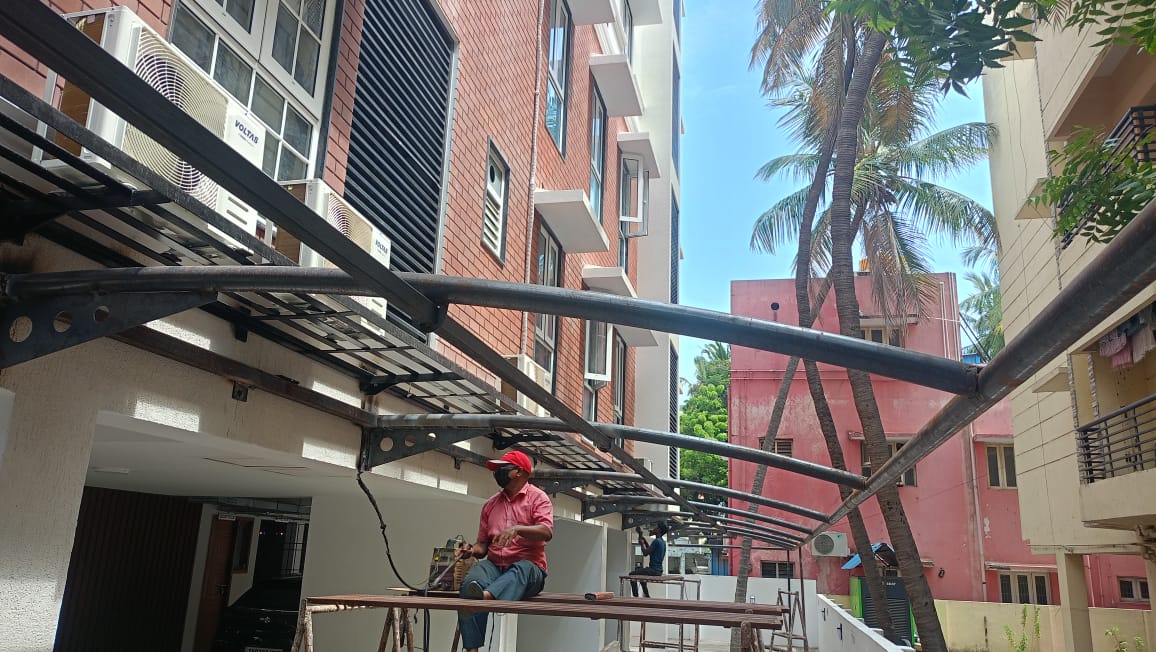

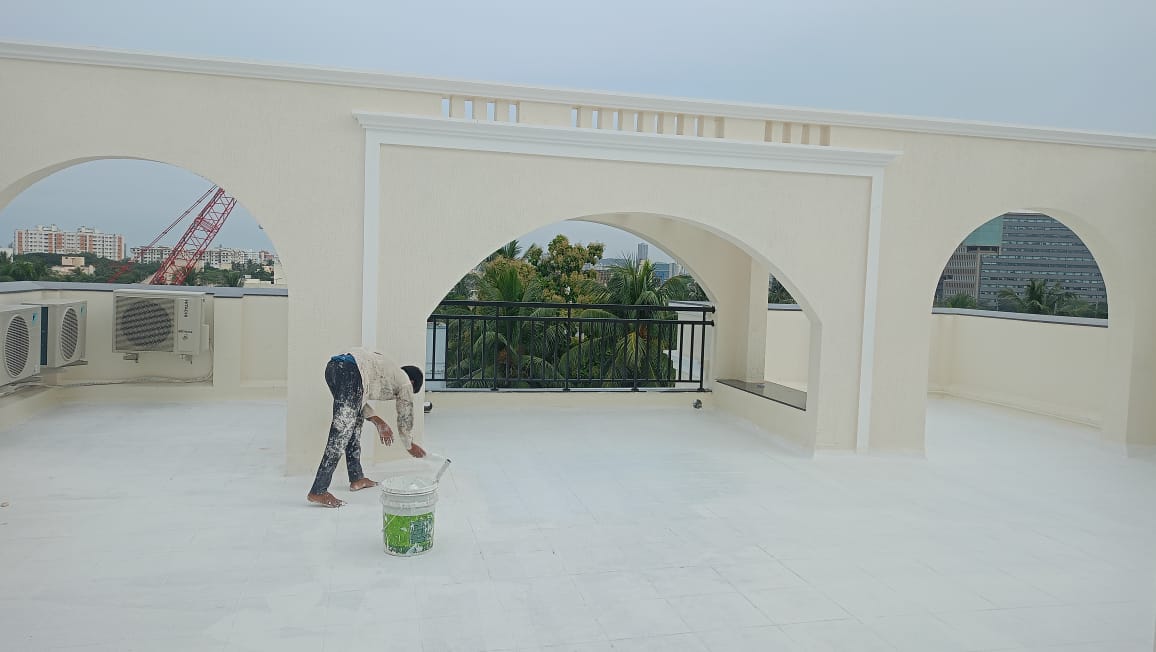

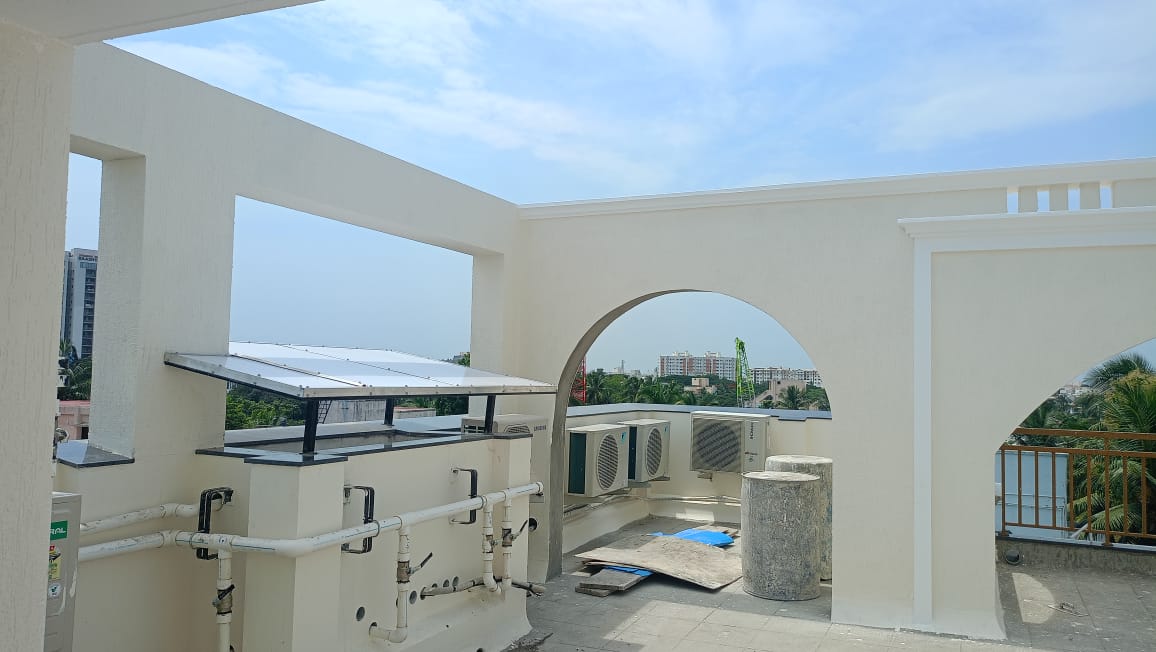

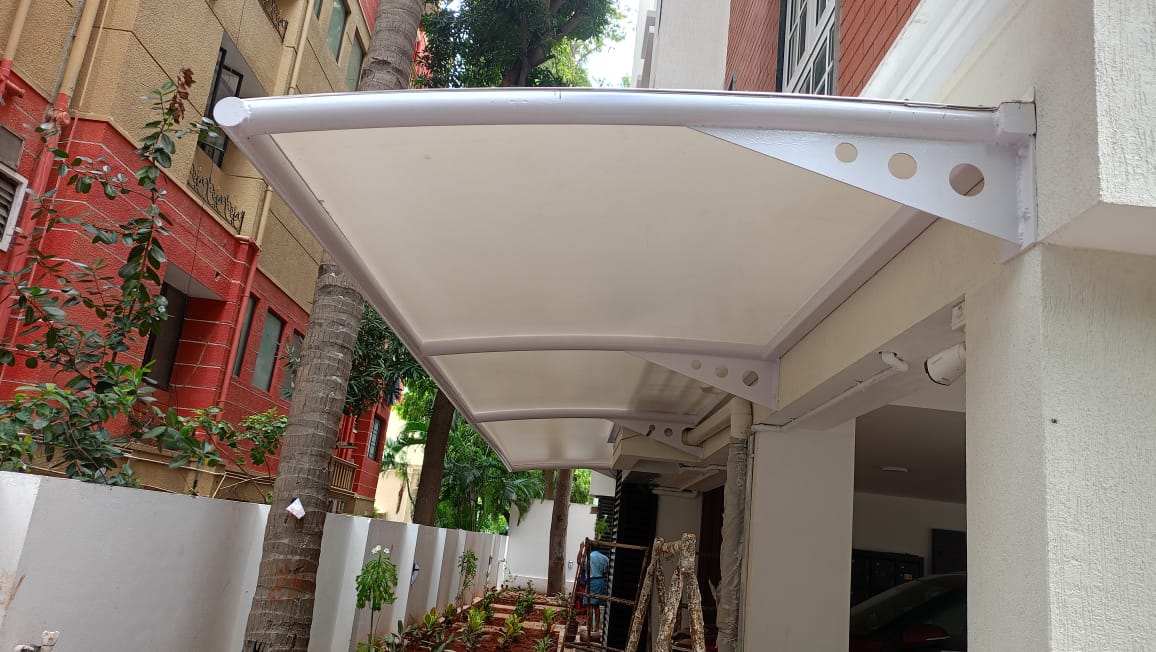

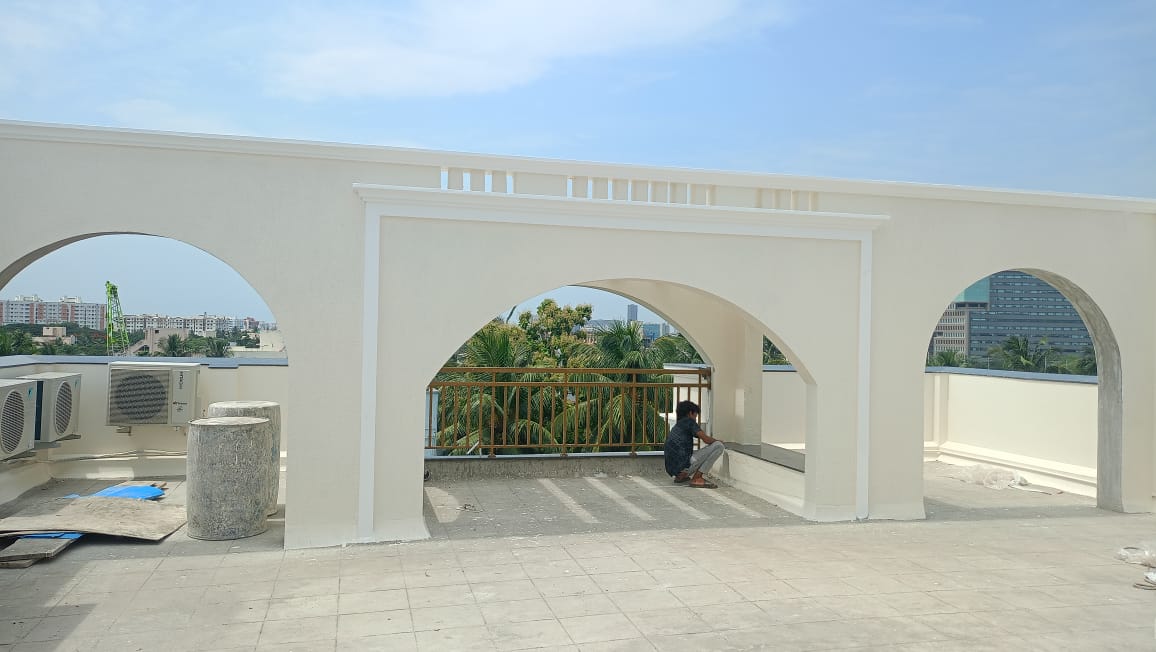

Project Update Images

  • 5th floor toilet wall concealed pipe line plumbing work is completed
  • 4th floor toilet wall tile laying work is in progress.
  • 1st, 2nd & 3rd floor general flooring work is in progress. (50% completed)
  • All floors window jambs granite fixing work is 80% completed.
  • External duct plumbing work is in progress.
  • Elevation tile laying work is in progress.
  • External plastering work is completed.
  • 4th floor toilet wall tile laying work is in progress. (80% completed)
  • 1st, 2nd, 3rd & 4h floor general flooring work is in progress. (50% completed)
  • External duct plumbing work is in progress.
  • Elevation tile laying work is in progress. (60% completed)
  • Terrace floor weathering course work is in progress.
  • 5th floor toilet wall tile laying work is in progress. (50% completed)
  • 1st floor general flooring work is in progress. (50% completed)
  • External duct plumbing work is in progress.
  • Elevation tile laying work is in progress. (75% completed)
  • Terrace floor weathering course work is in progress.
  • 5th floor toilet wall tile laying work is in progress. (70% completed)
  • 1st floor general flooring work is in progress. (50% completed)
  • External duct plumbing work is completed.
  • Elevation tile laying work is in progress. (80% completed)
  • Terrace floor weathering course work is in progress. (50% completed)
  • 5th floor toilet wall tile laying work is in progress. (70% completed)

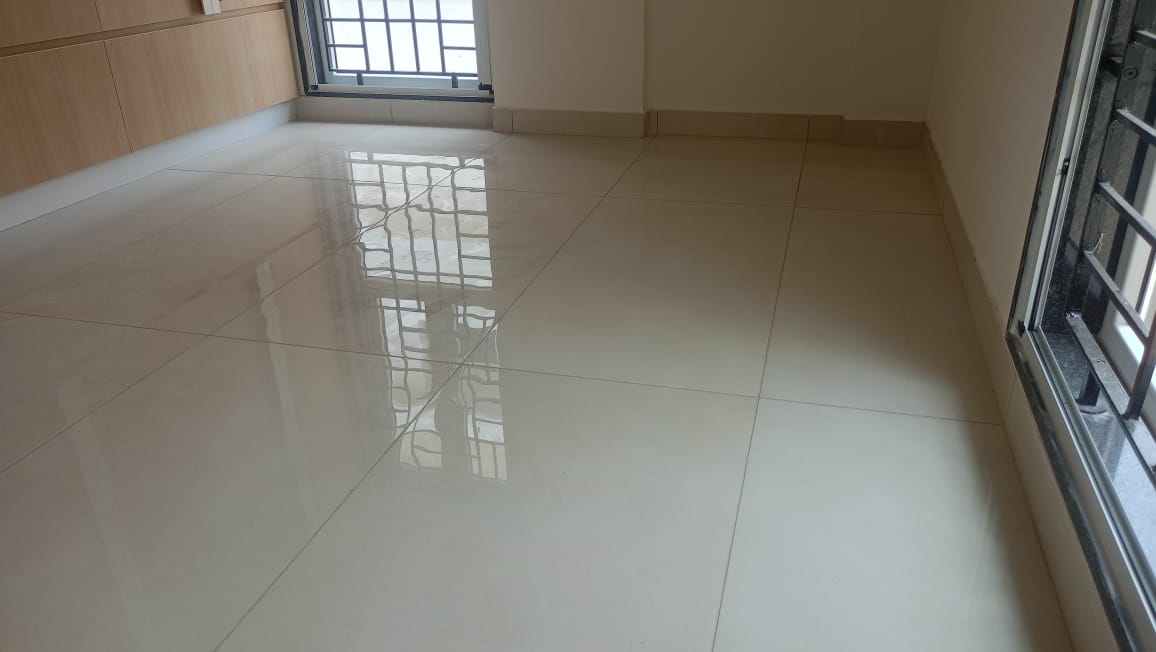

  • All floor general flooring work is completed.
  • All floor staircase flooring work is in progress.(50% completed).

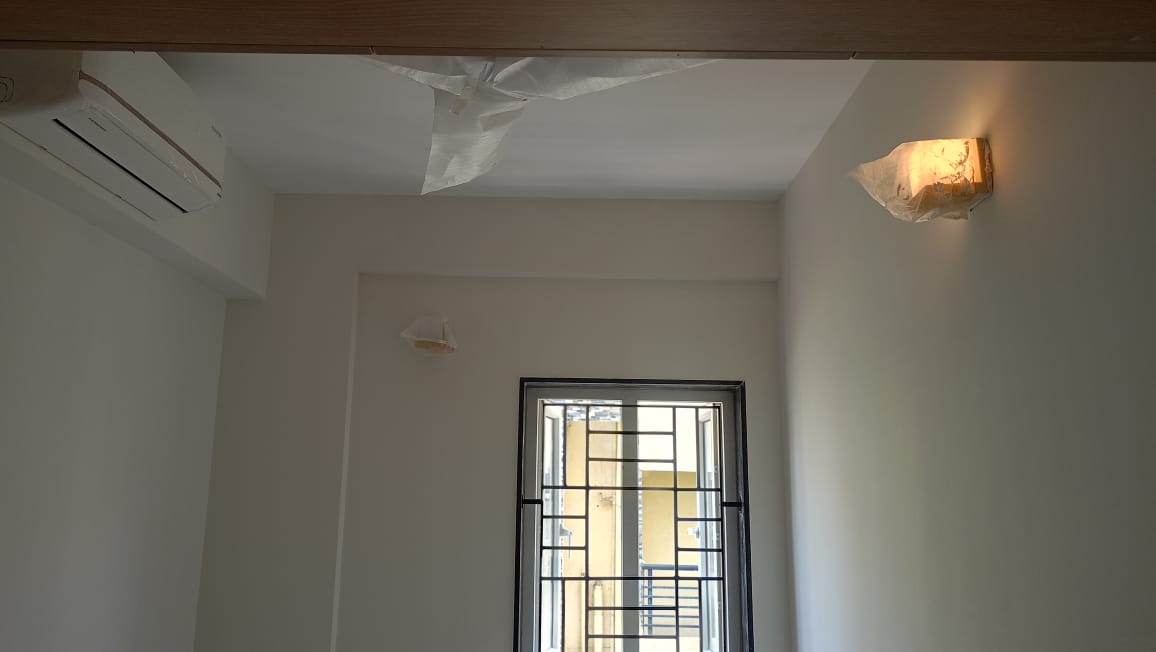

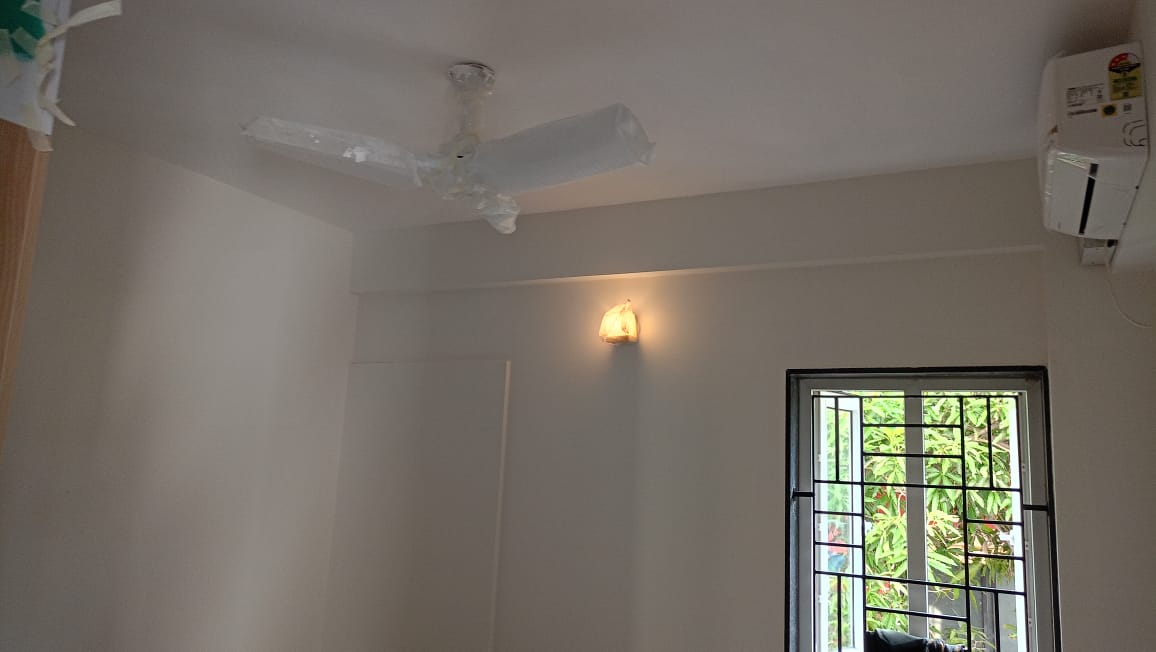

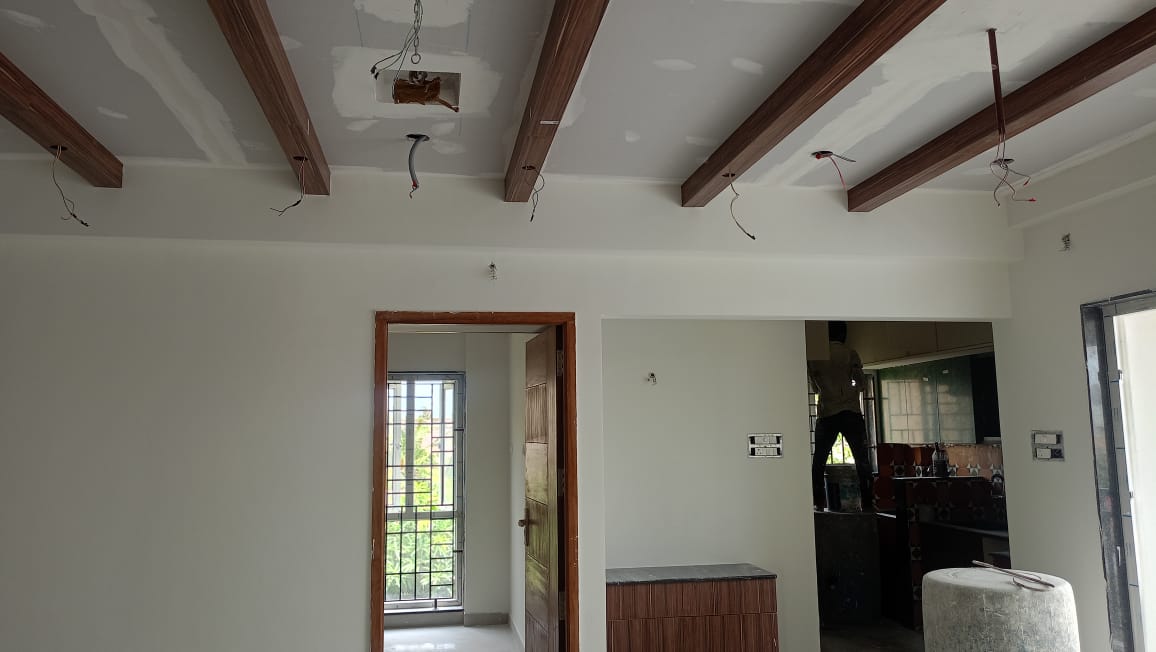

  • 1st , 2nd, 4th and 5th floor Inner putty work is in progress
  • Elevation tile laying work is completed
  • Terrace floor weathering course work is completed.
  • Outer primer work is in progress.
