Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Manasa

Anna Nagar

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV
Elevators
Multi Purpose Hall
Rain Water Harvesting

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
104 1 3BHK + 3T 1700 East Available
106 1 3BHK + 3T 1700 East Available
202 2 3BHK + 3T 1700 East Available
206 2 3BHK + 3T 1700 East Available
604 6 3BHK + 3T 1700 East Available
704 7 3BHK + 3T 1700 East Available
804 8 3BHK + 3T 1700 East Available
902 9 3BHK + 3T 1700 East Available
904 9 3BHK + 3T 1700 East Available
903 9 3BHK + 3T 1700 North Available
906 9 3BHK + 3T 1700 East Available
504 5 3BHK + 3T 1700 East Available
102 1 3BHK + 3T 1700 East Available

Approvals

Planning Permit No:

PP/HRB/06/2024/A to D

Date of Permit:

2024-05-16

Building Permission No:

CEBA / WDCN08 / 00217 / 2024

Date of Permit:

2024-05-25

TNRERA:

TN/29/Building/0460/2024

Dated:

2024-09-03

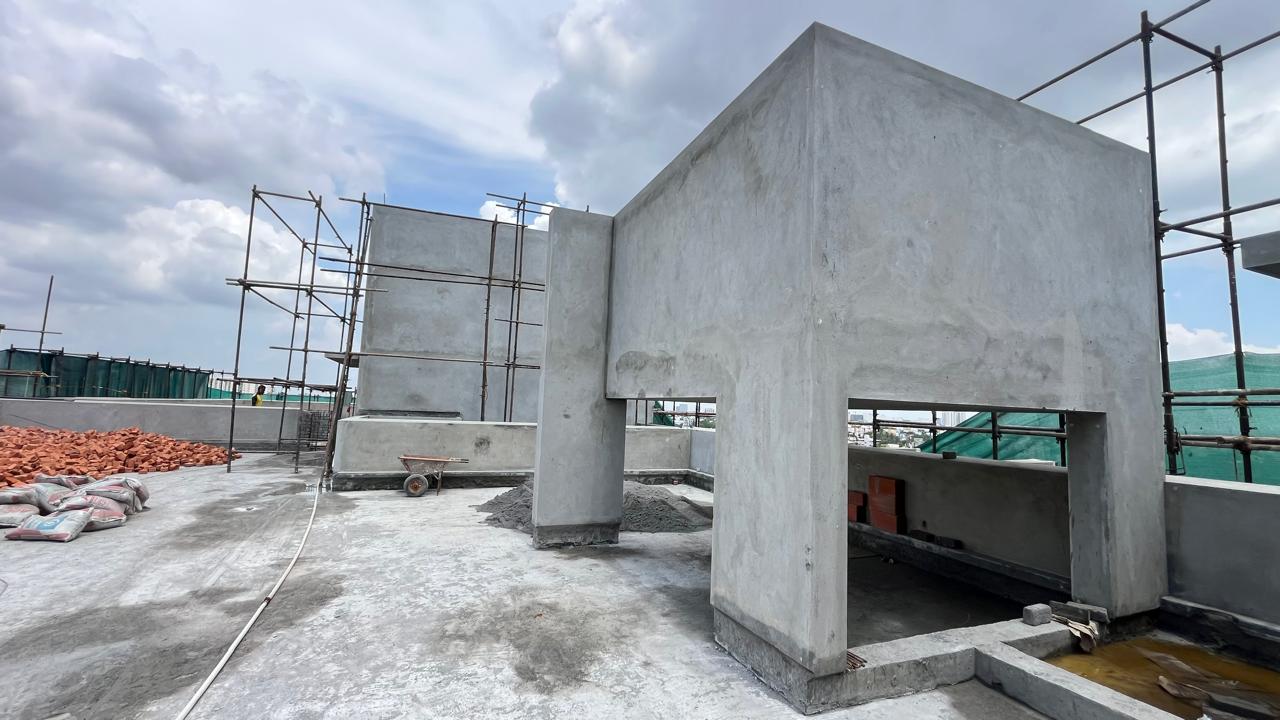

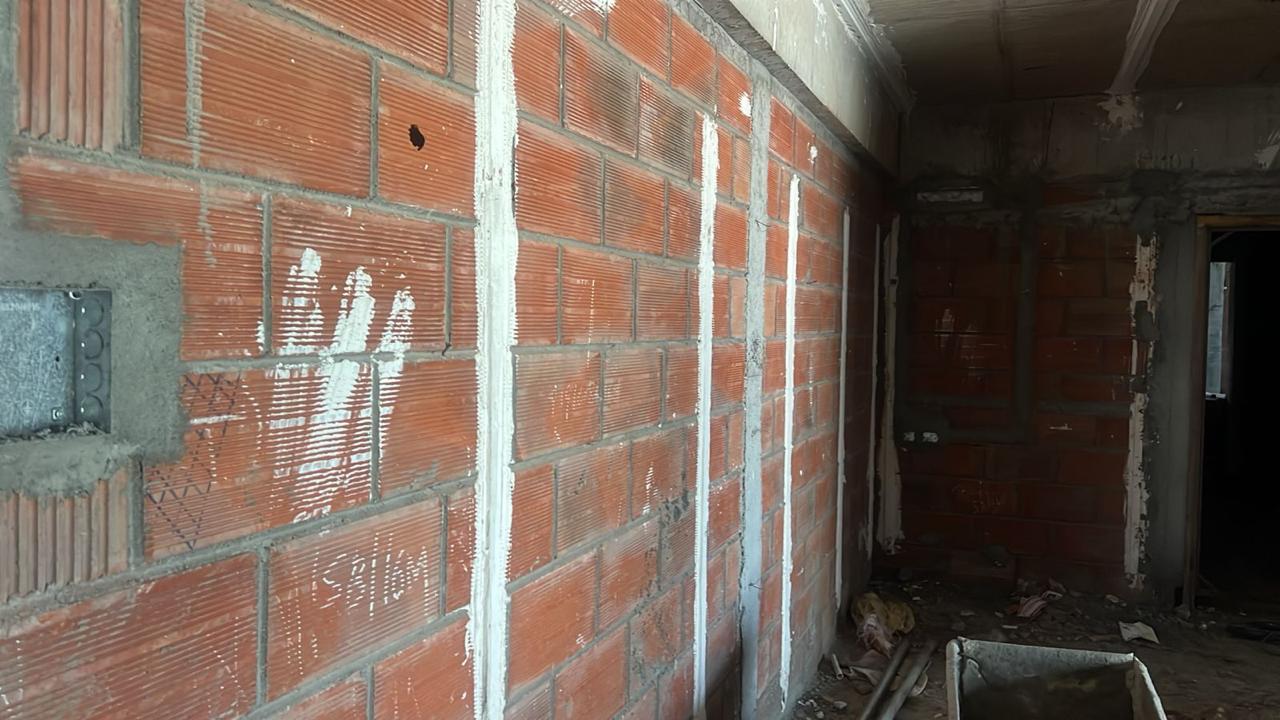

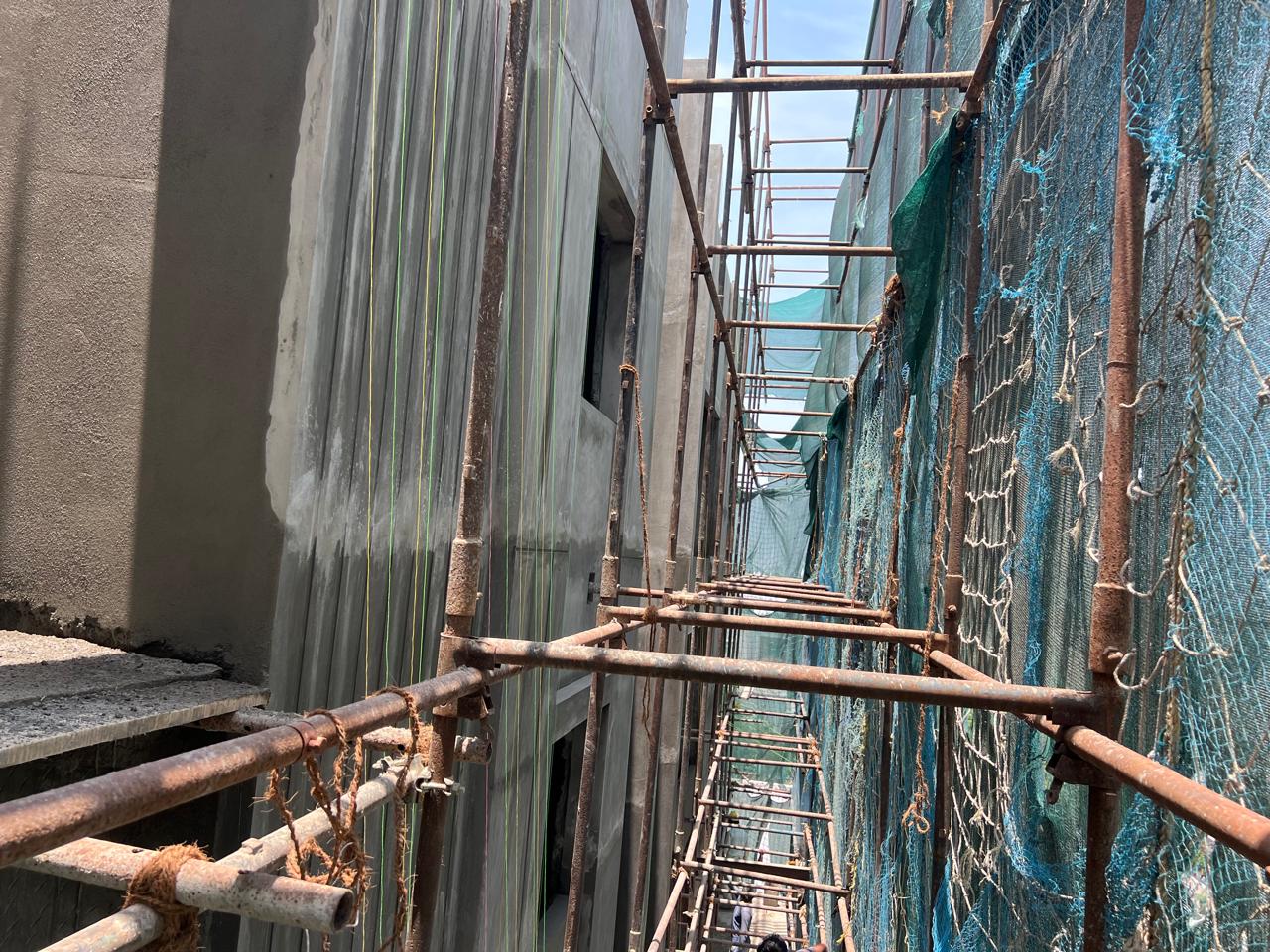

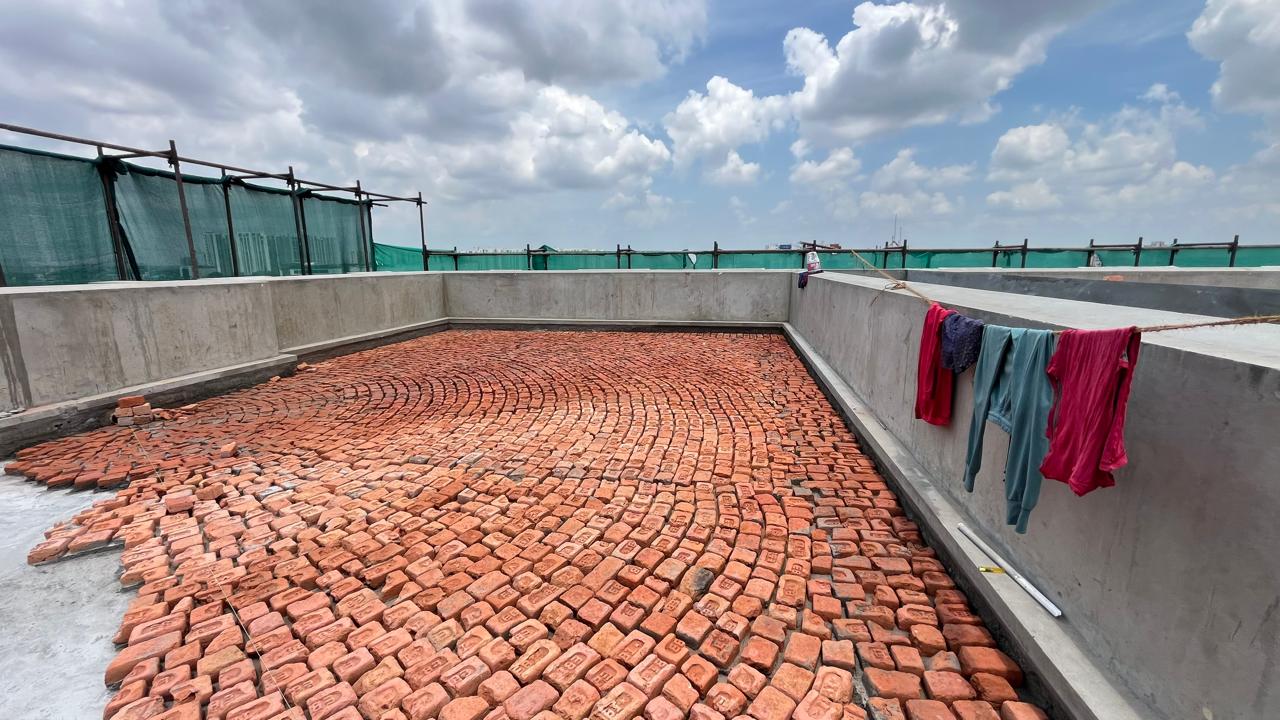

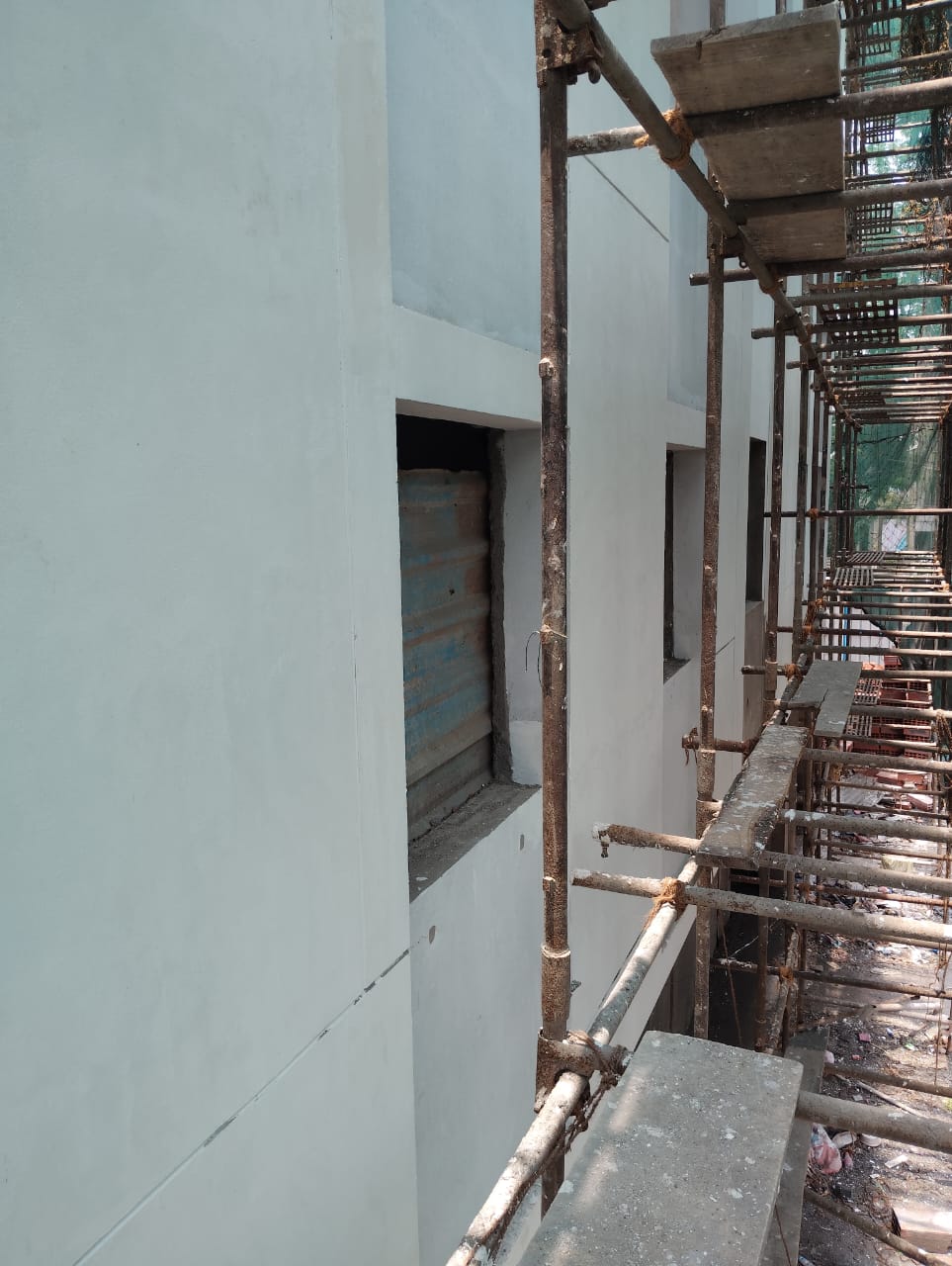

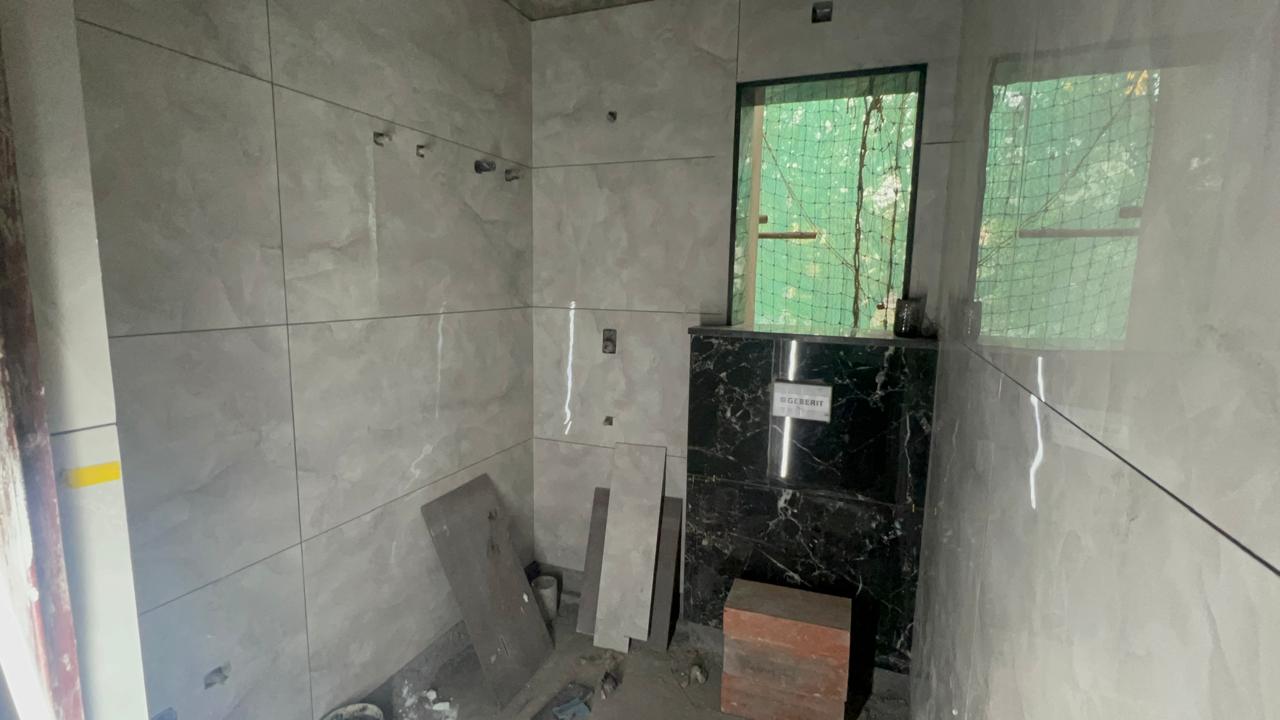

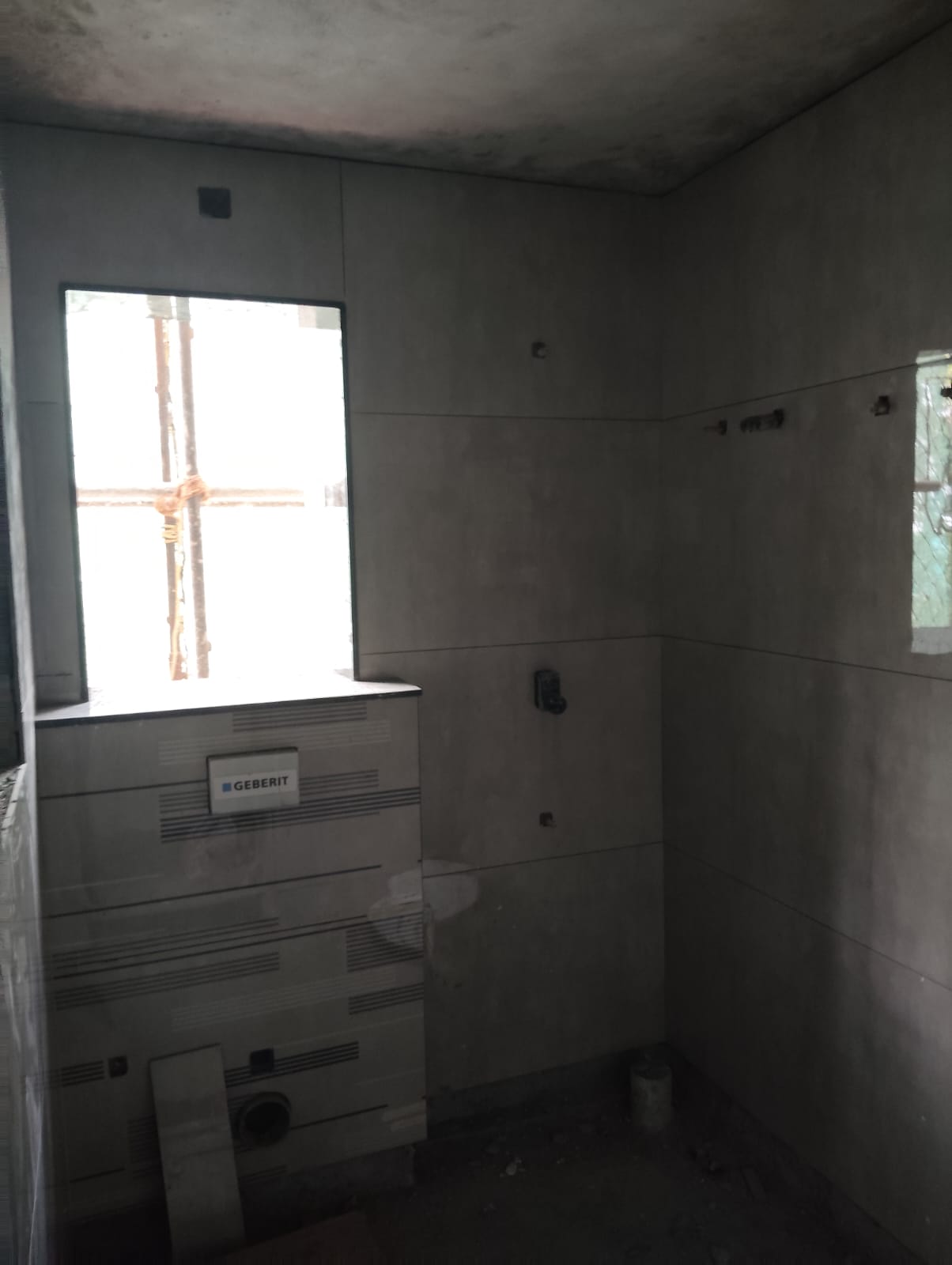

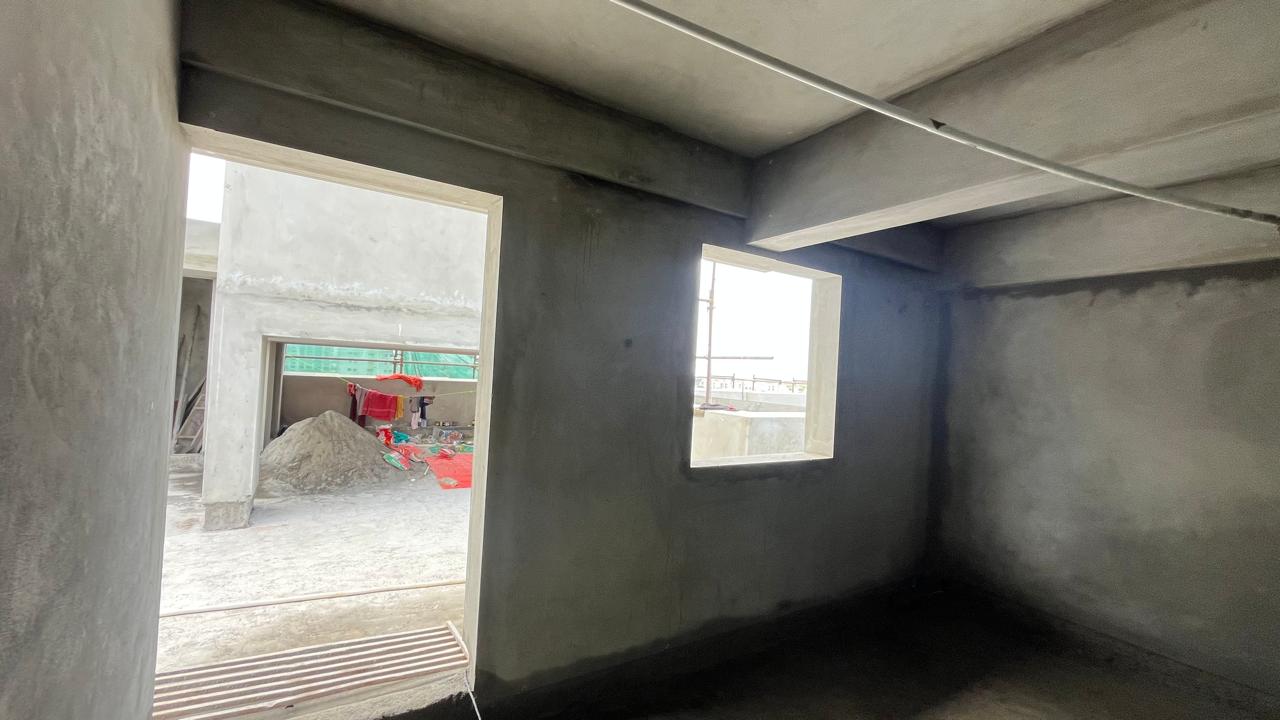

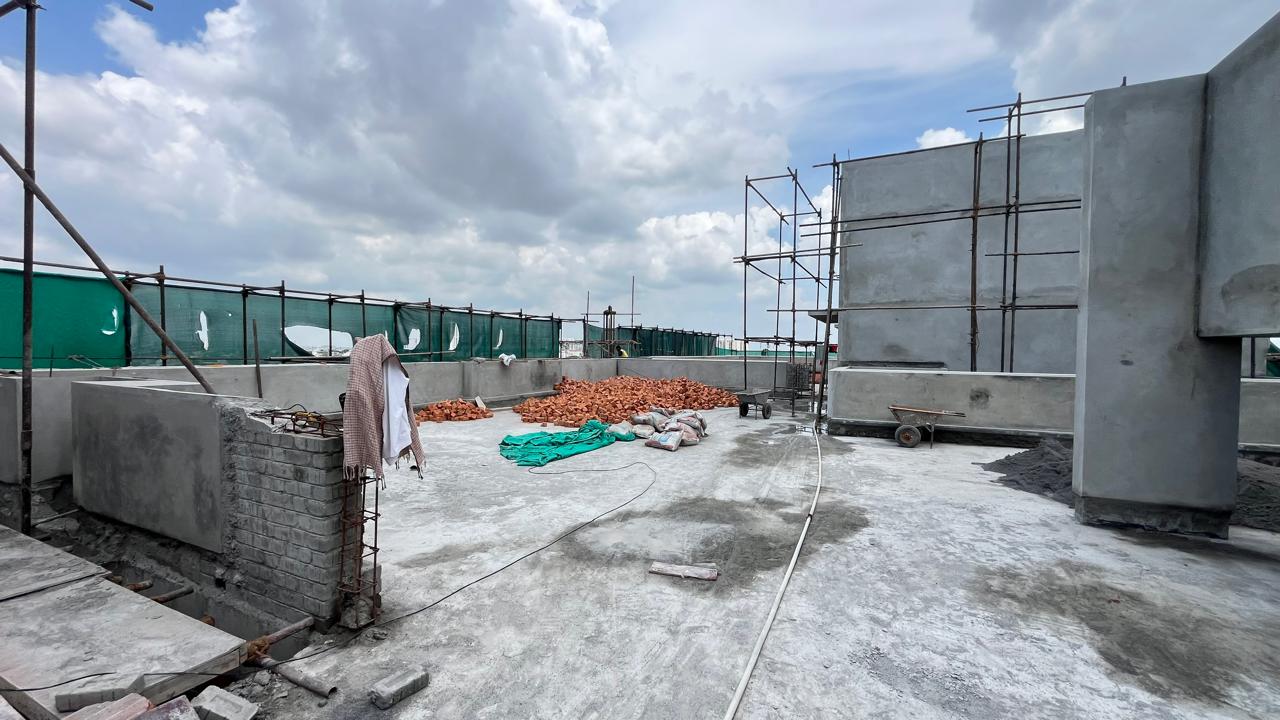

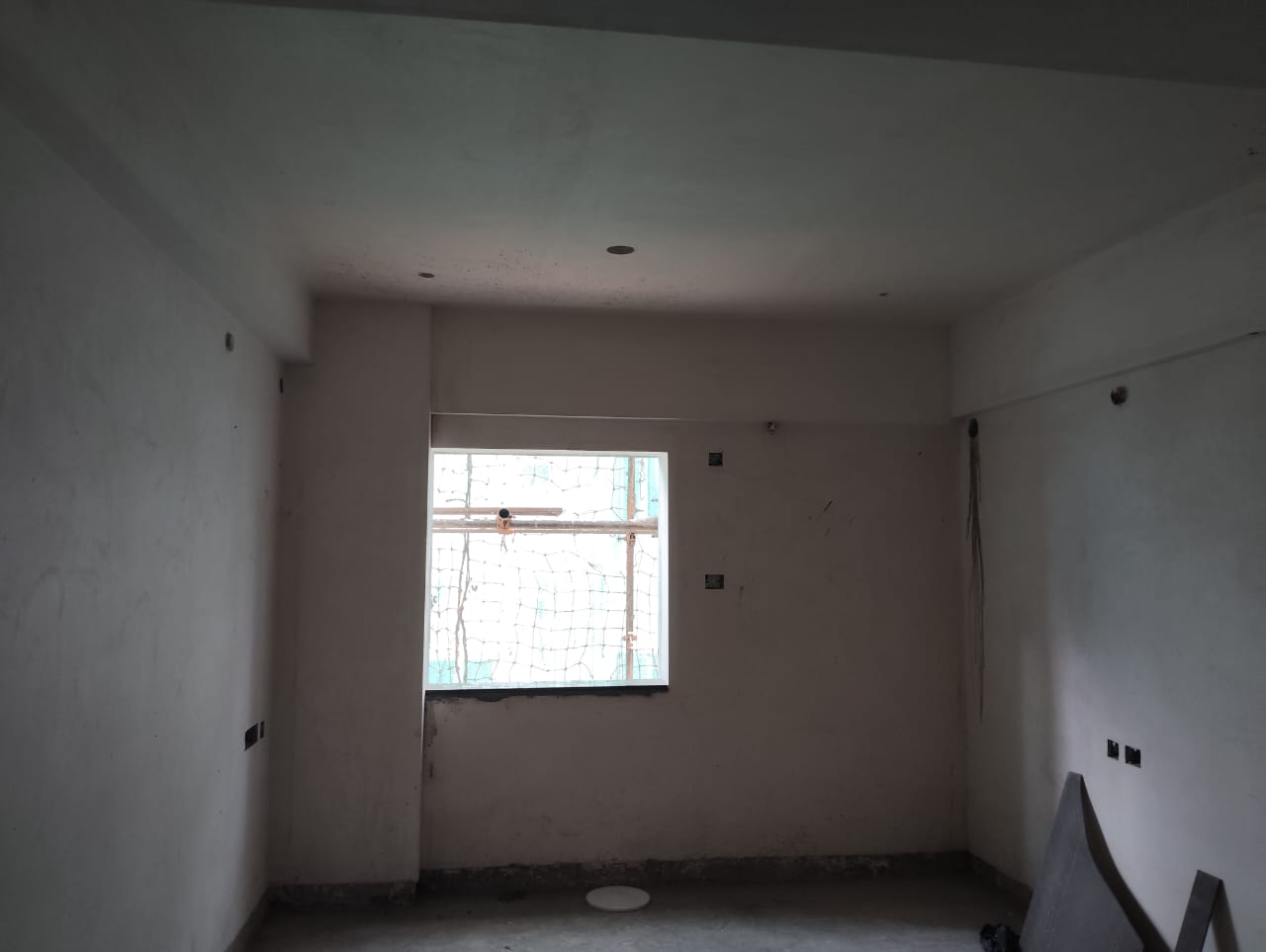

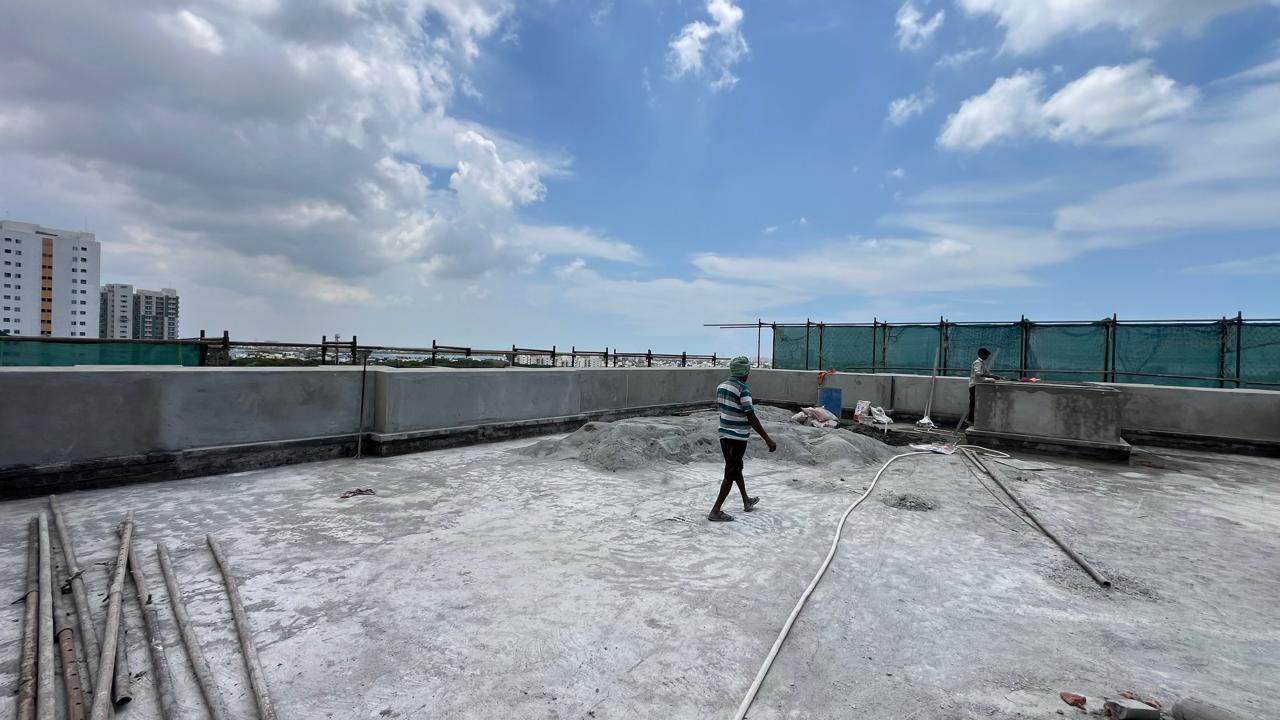

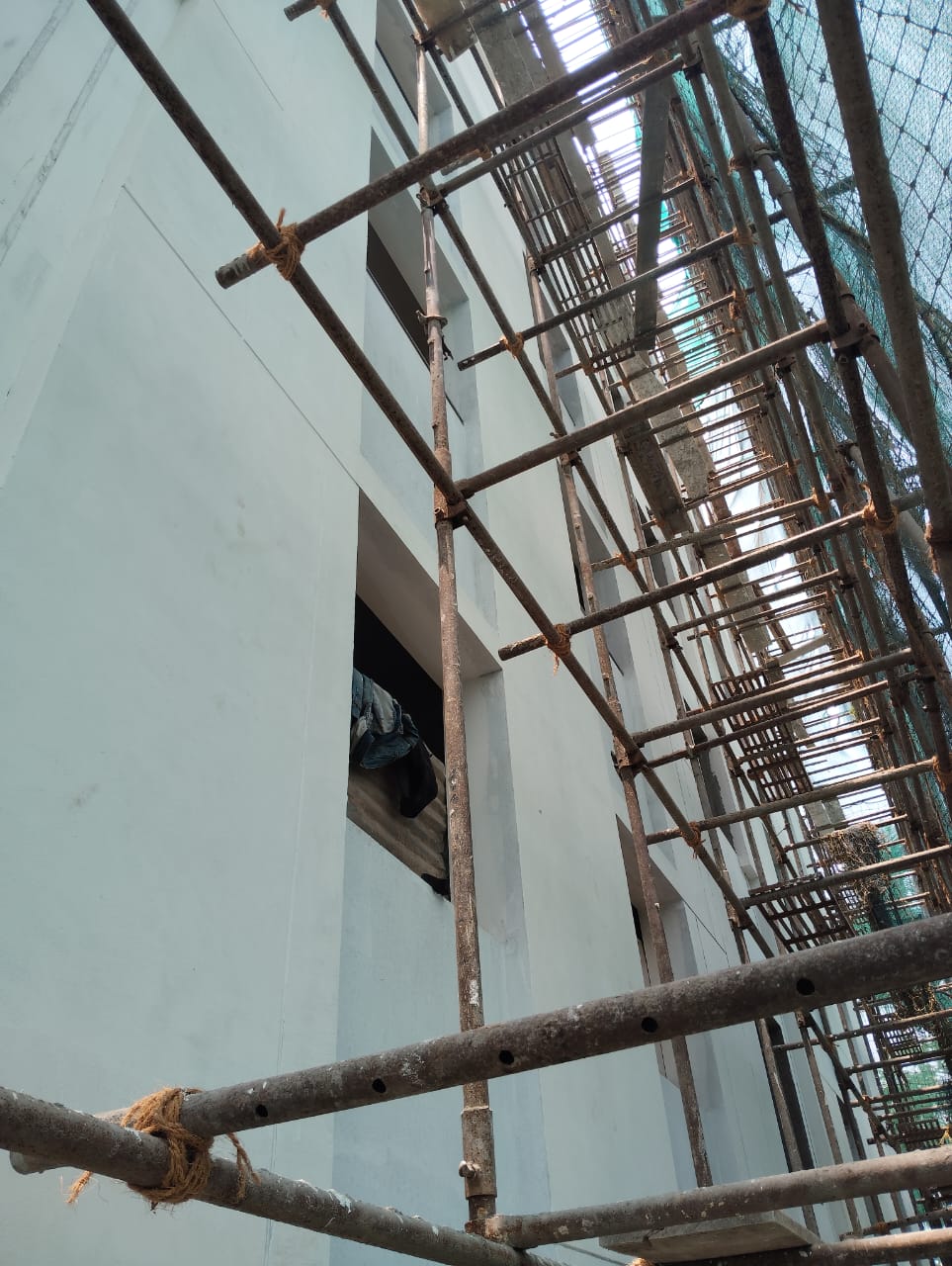

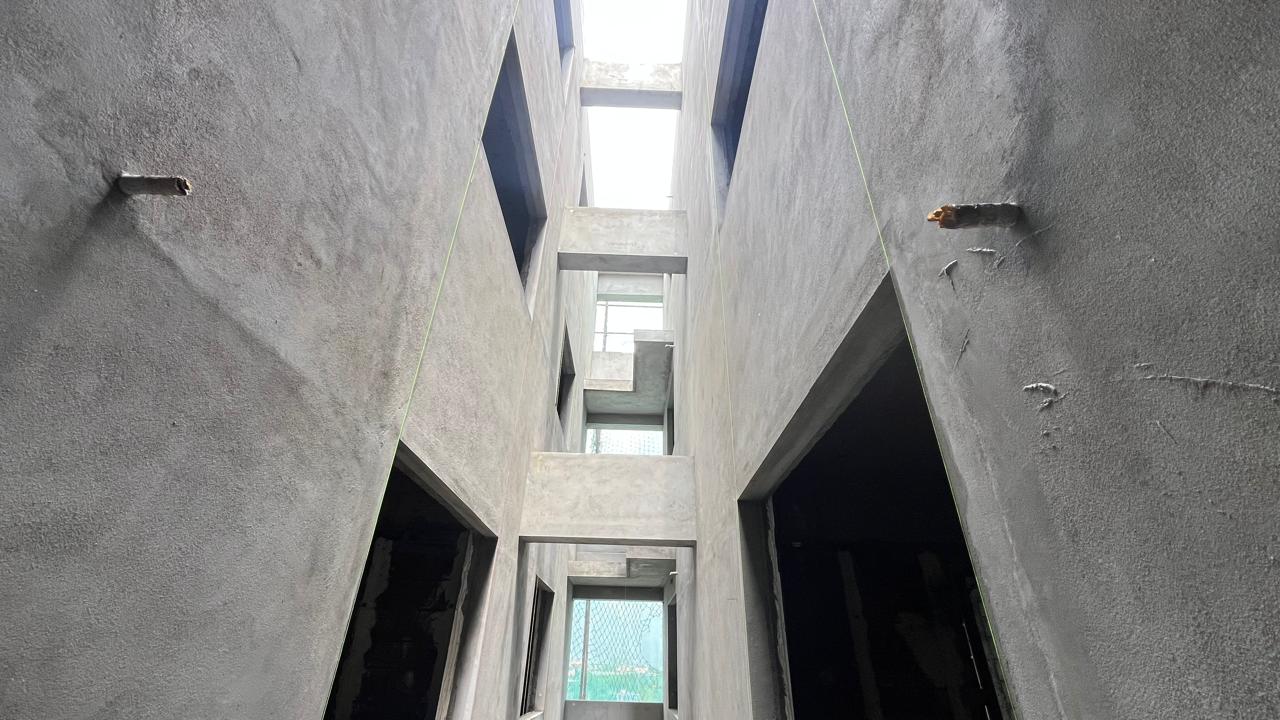

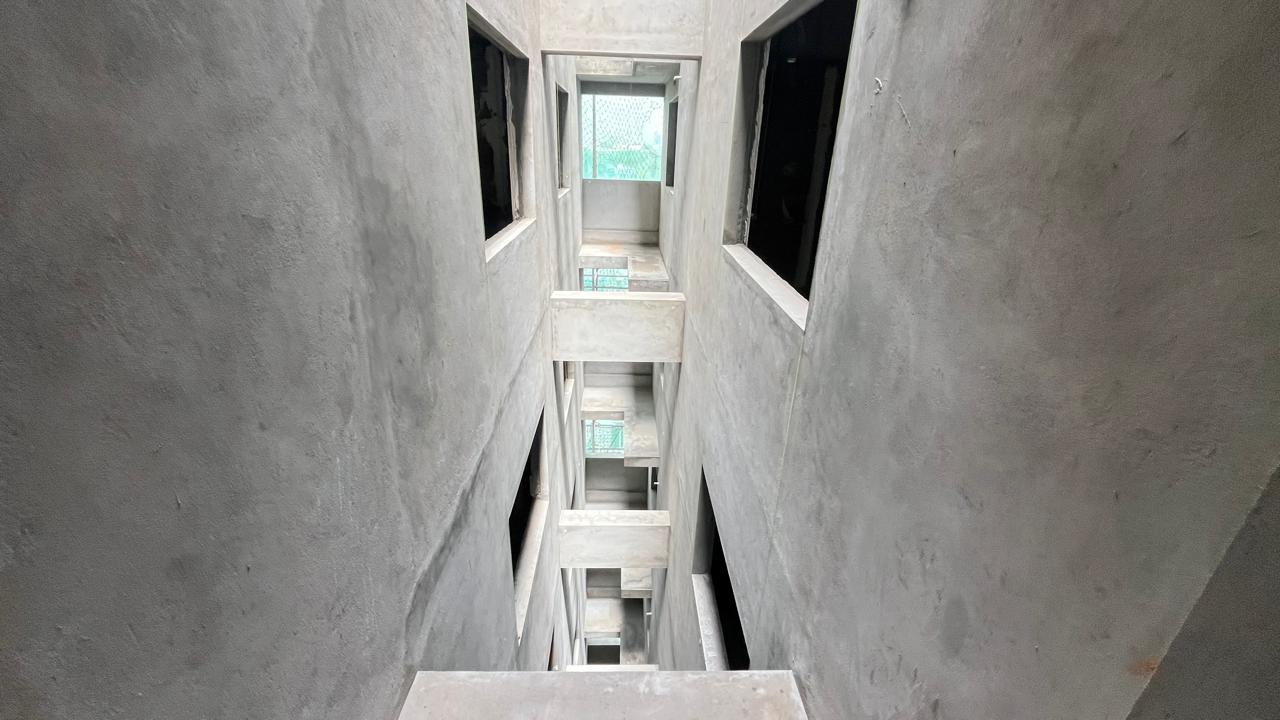

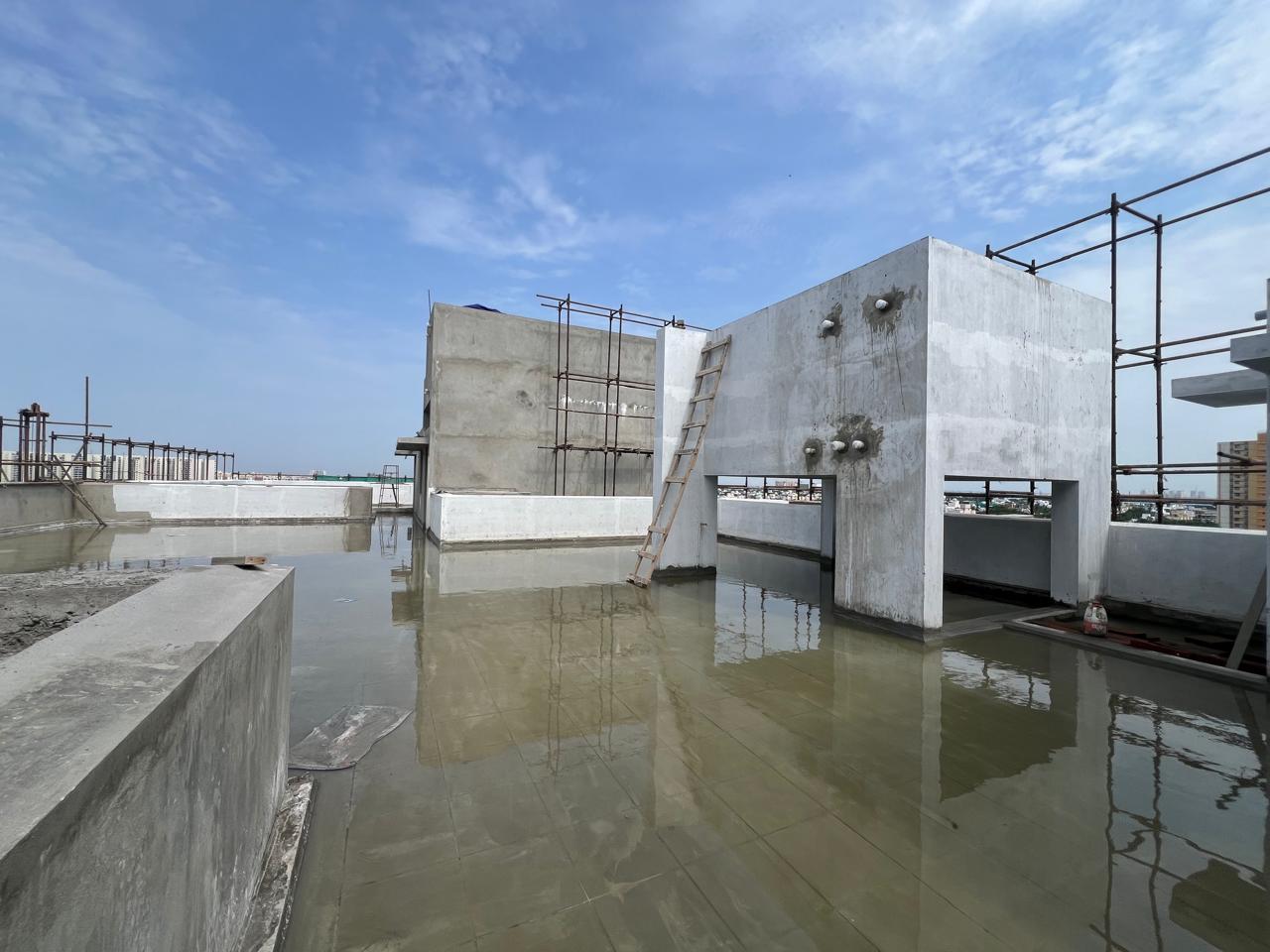

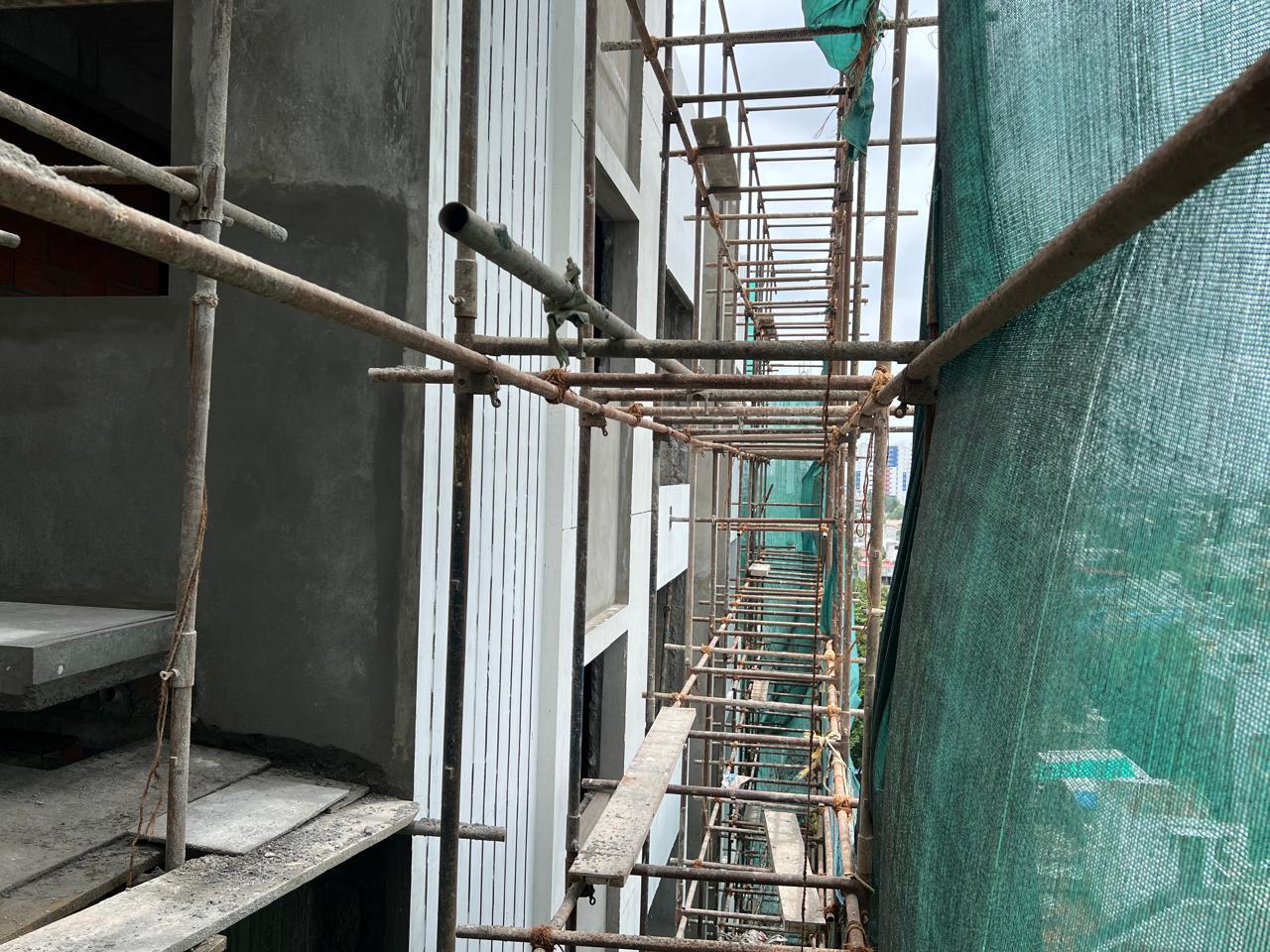

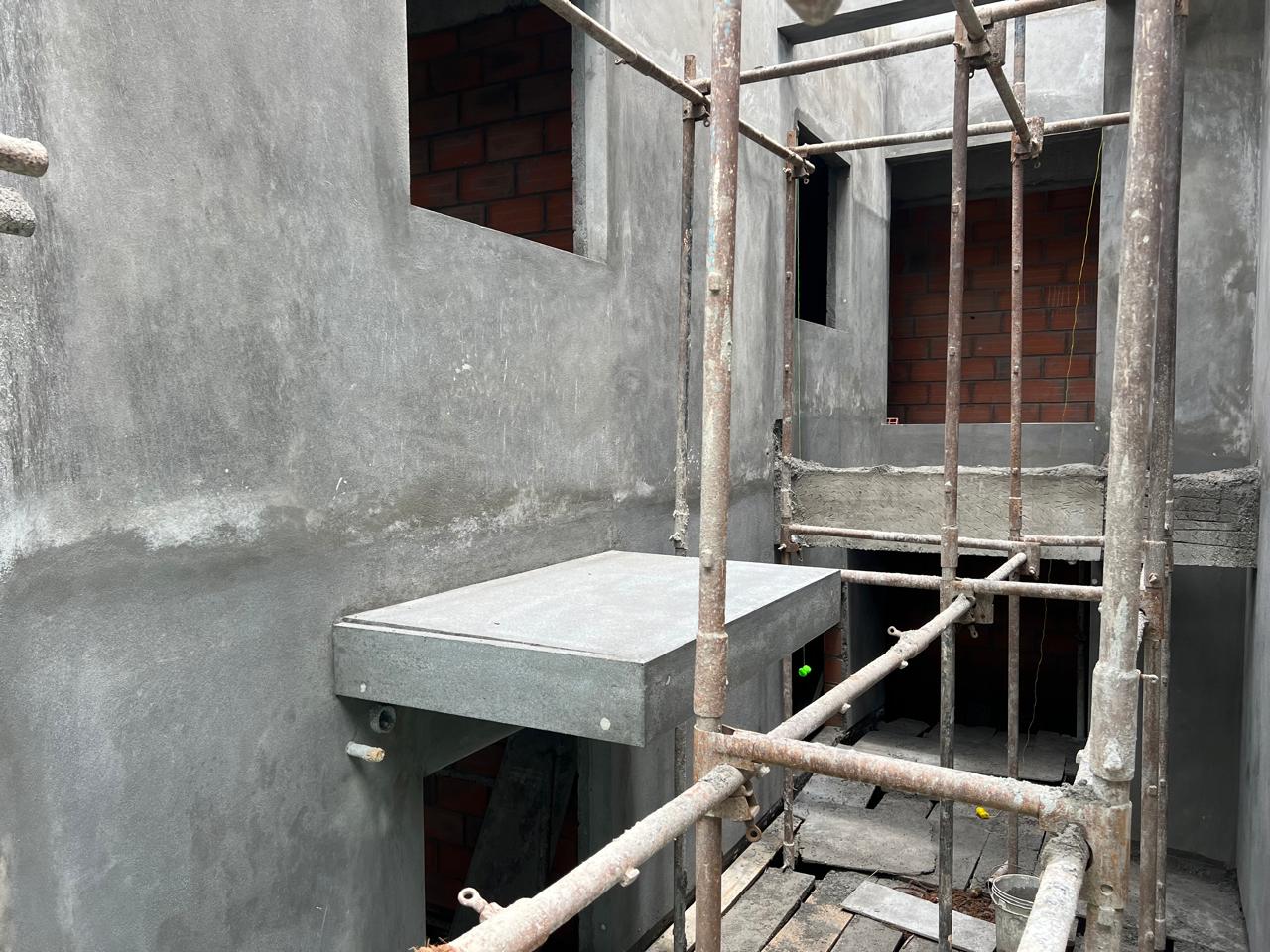

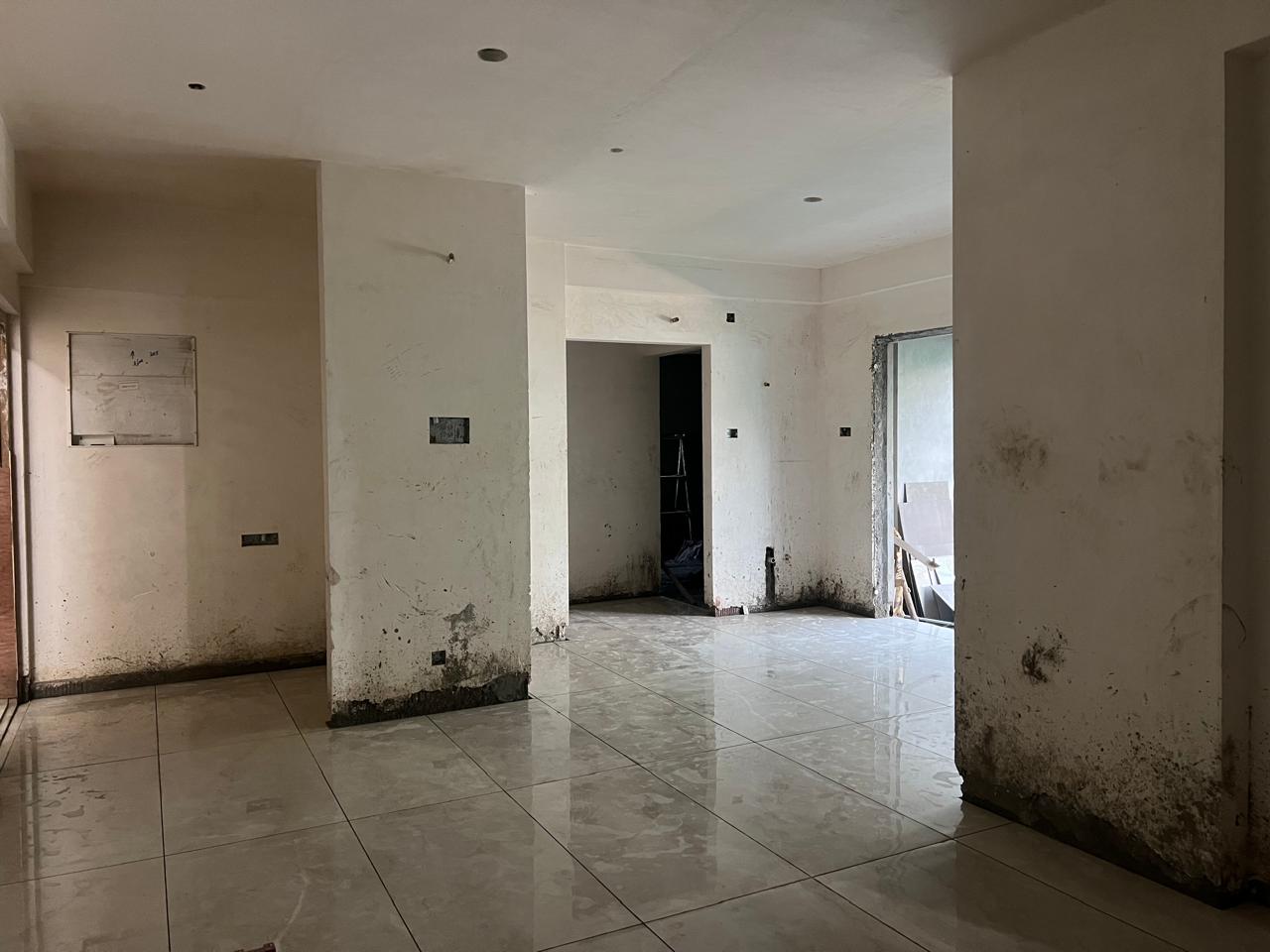

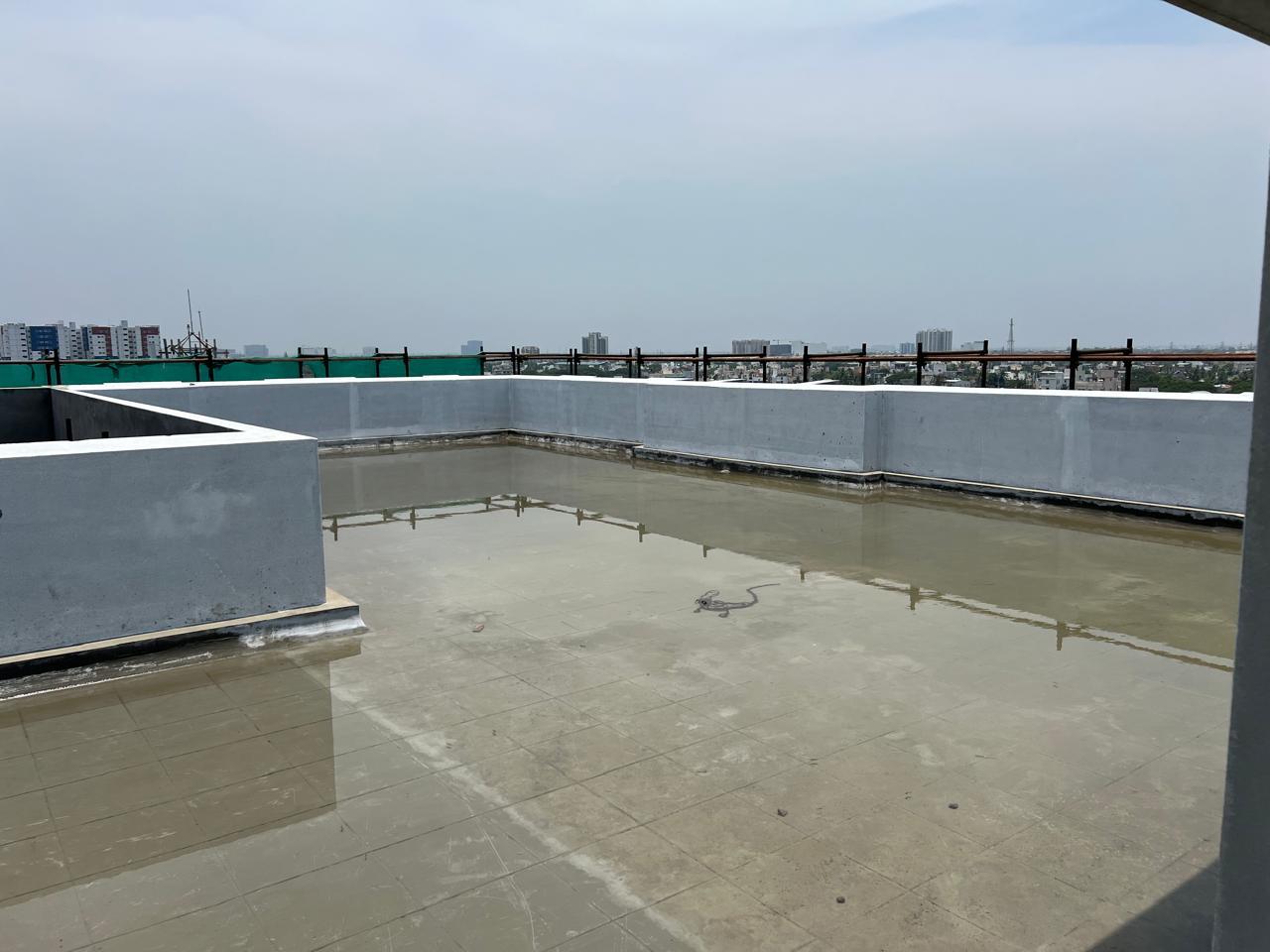

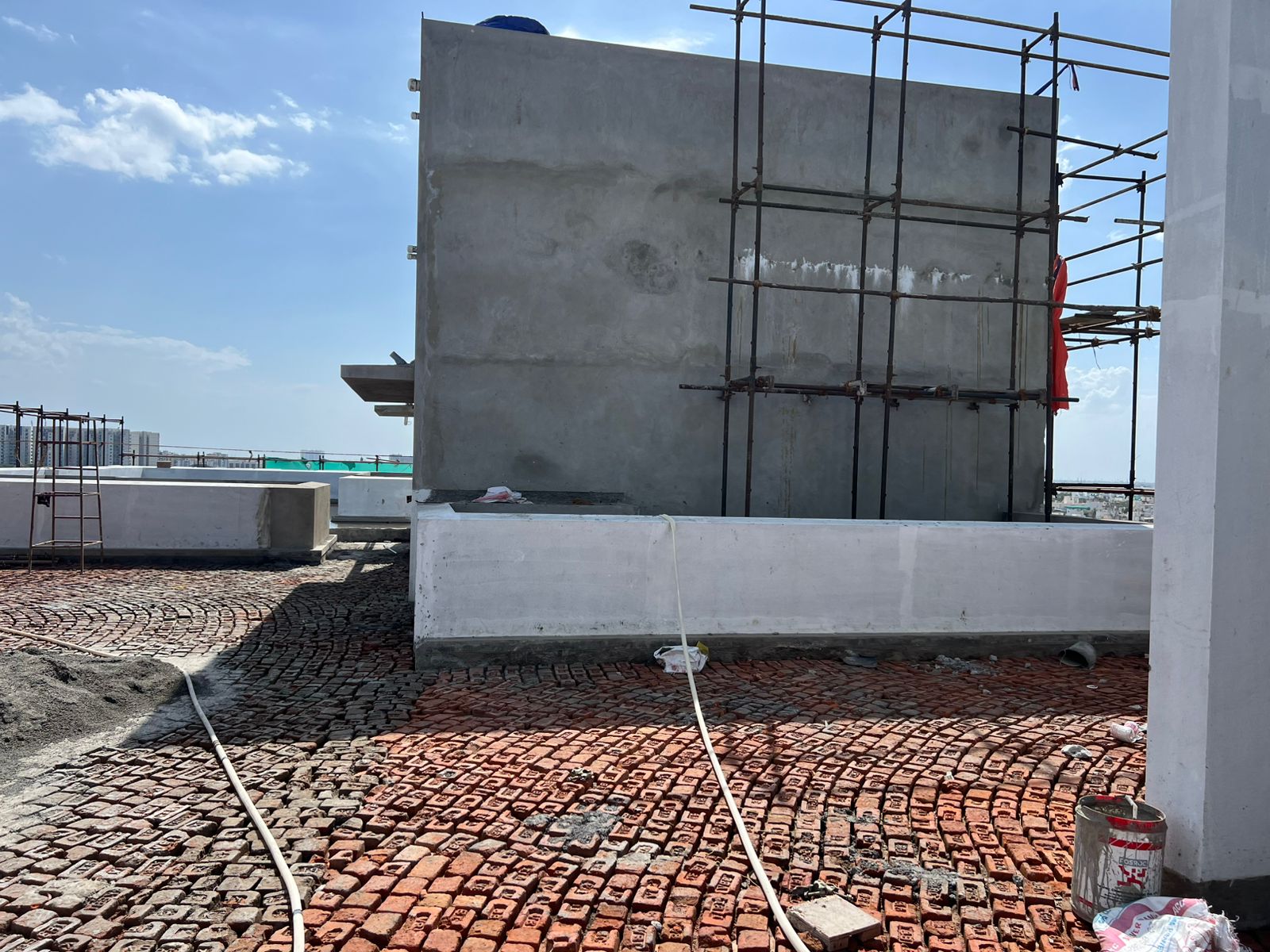

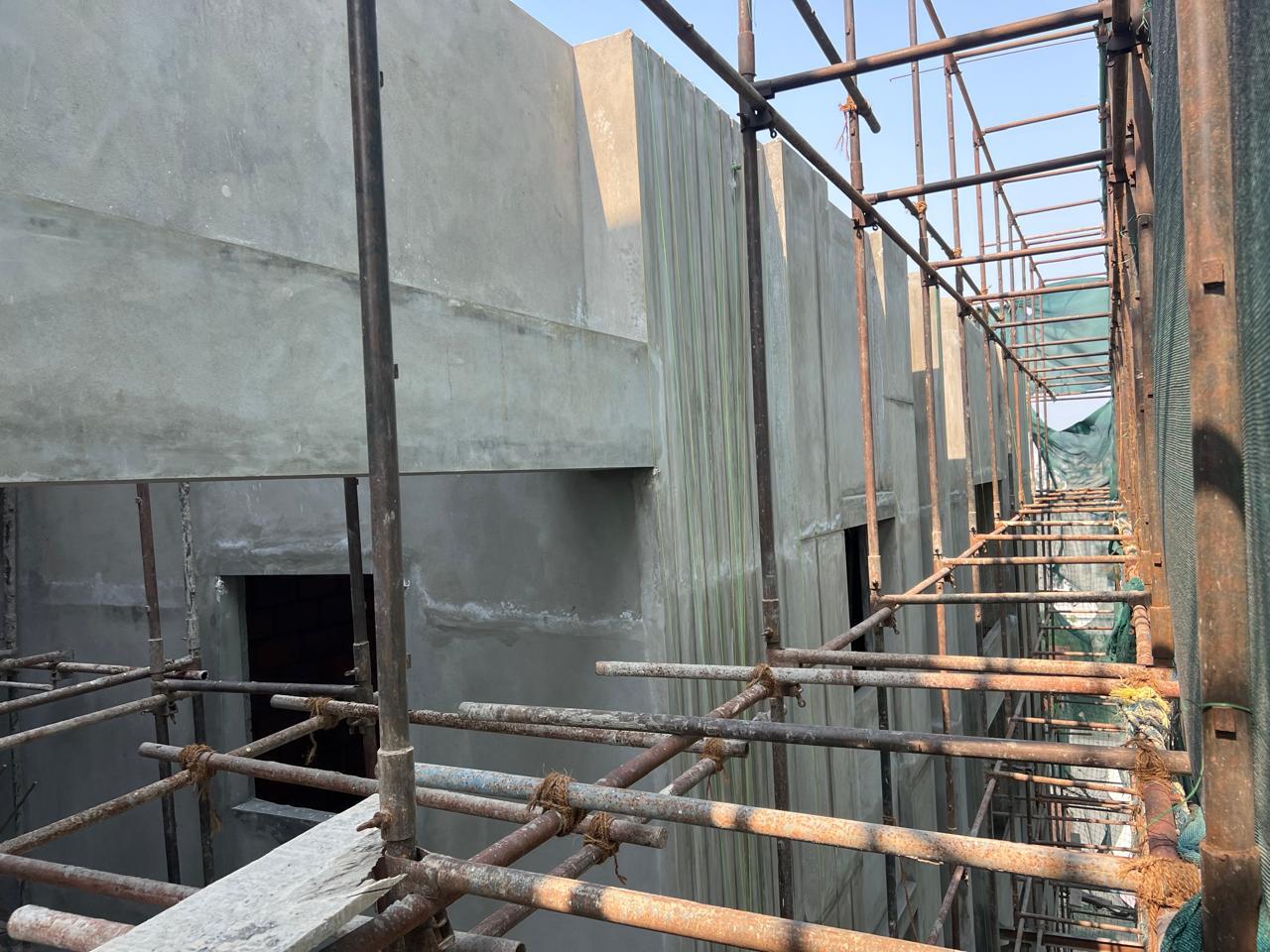

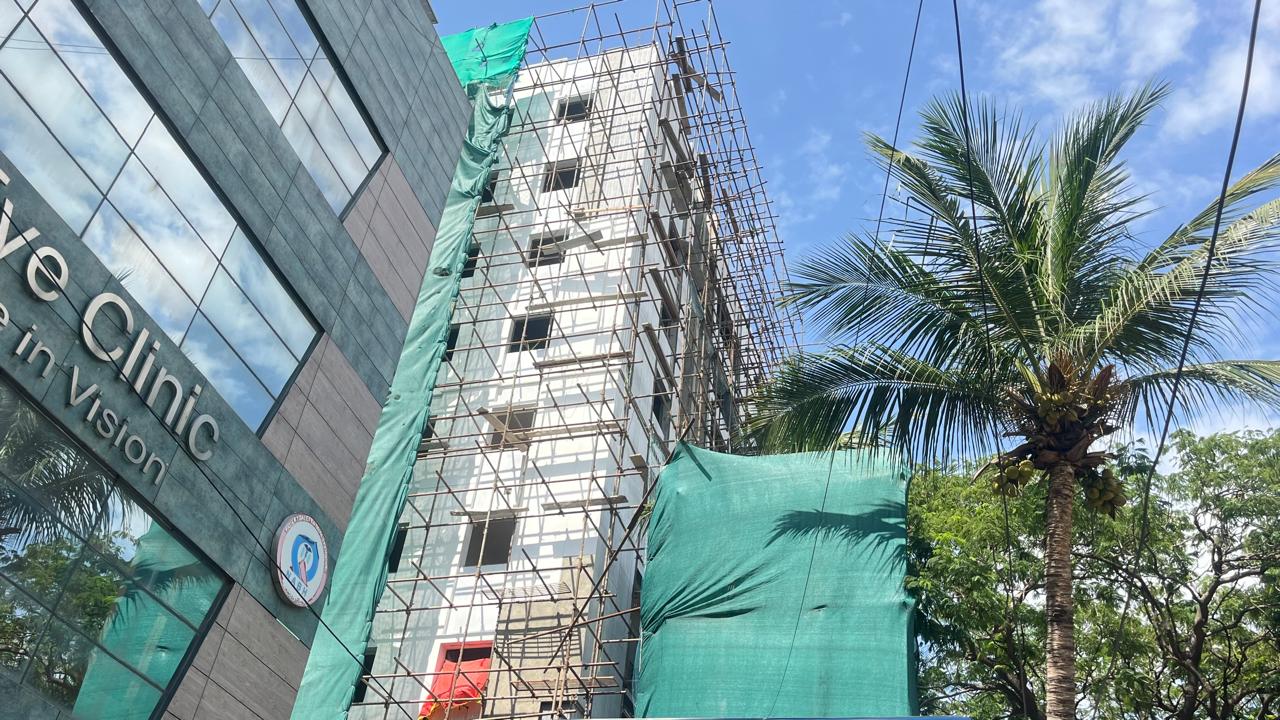

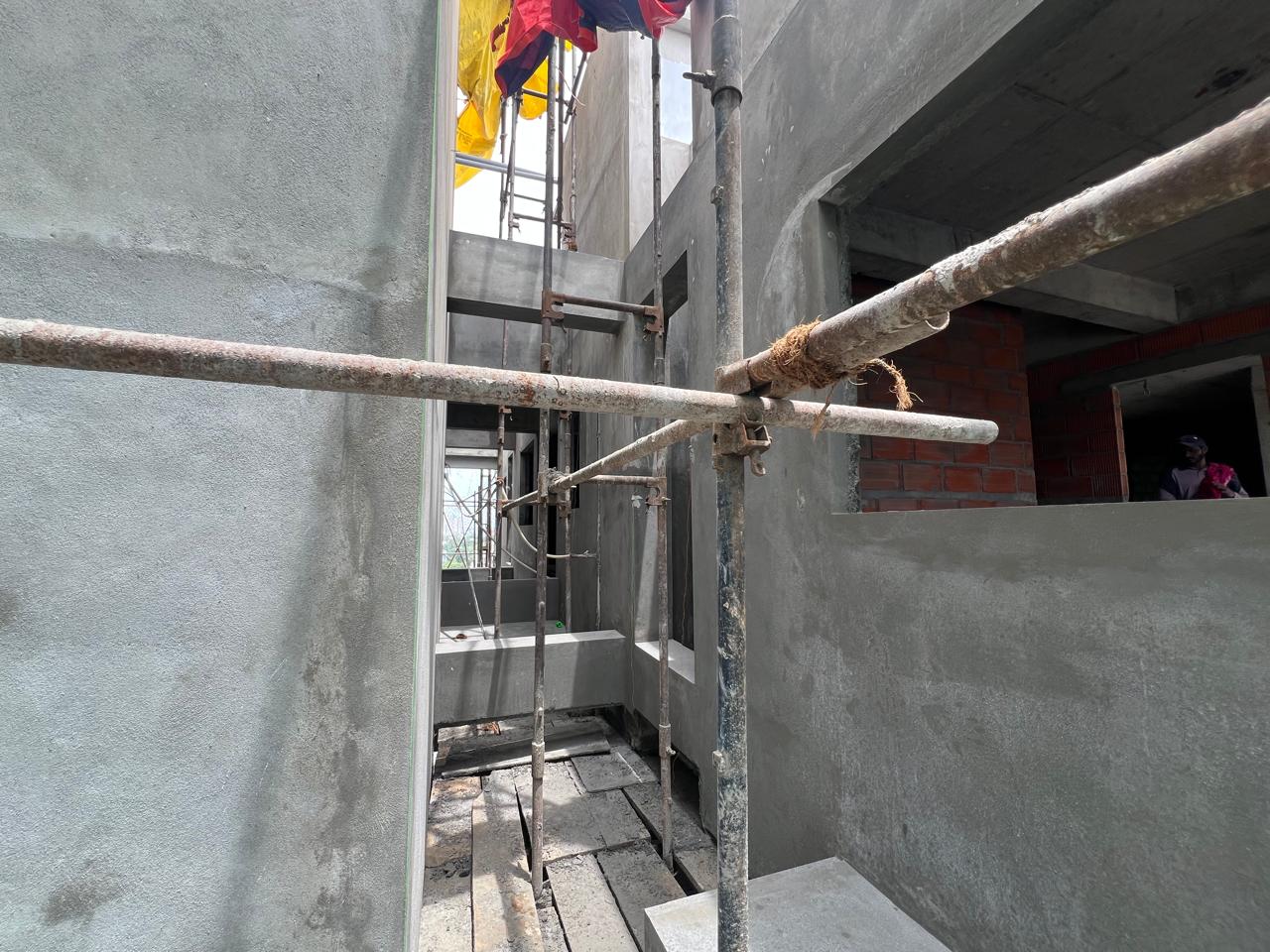

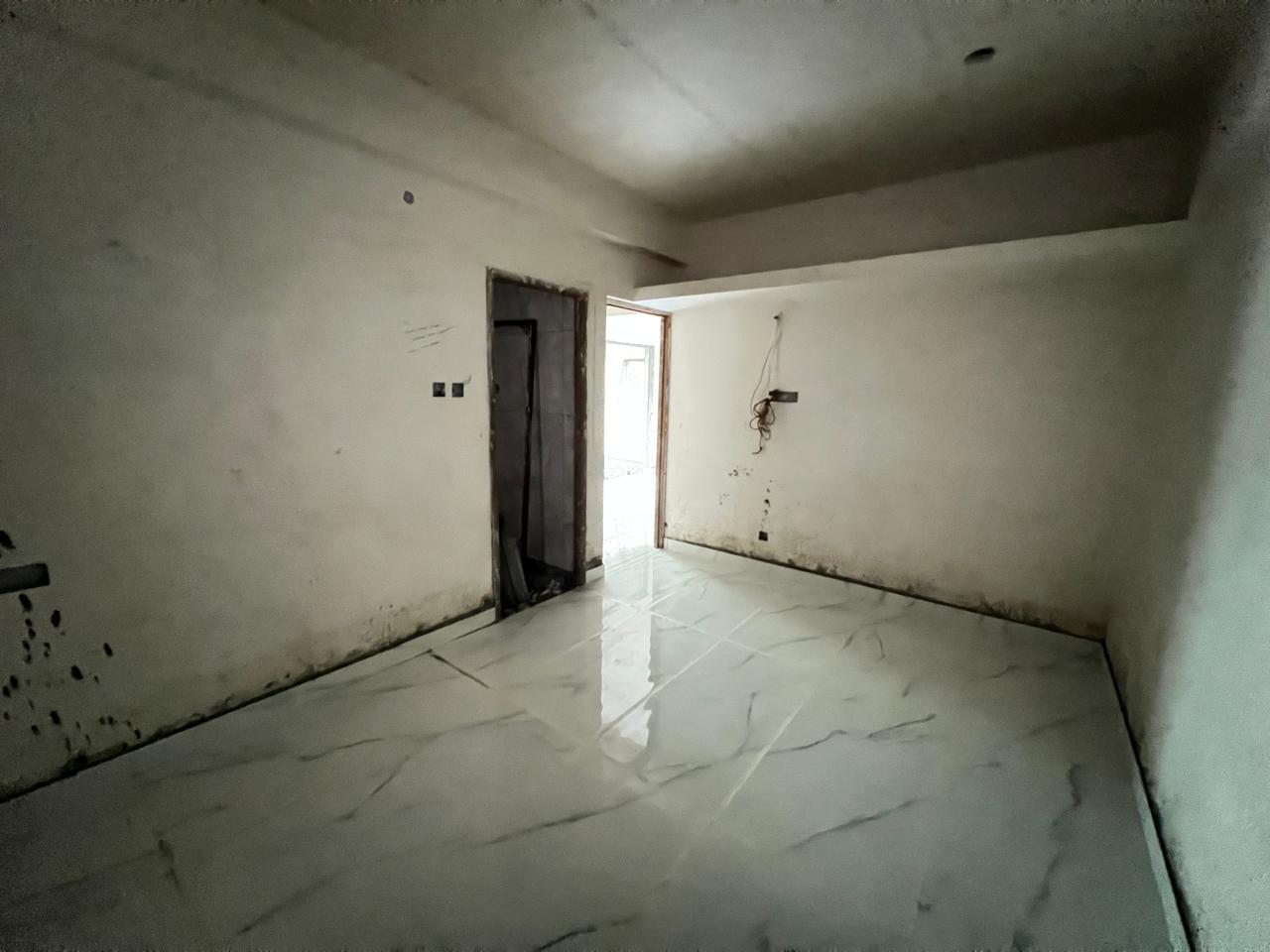

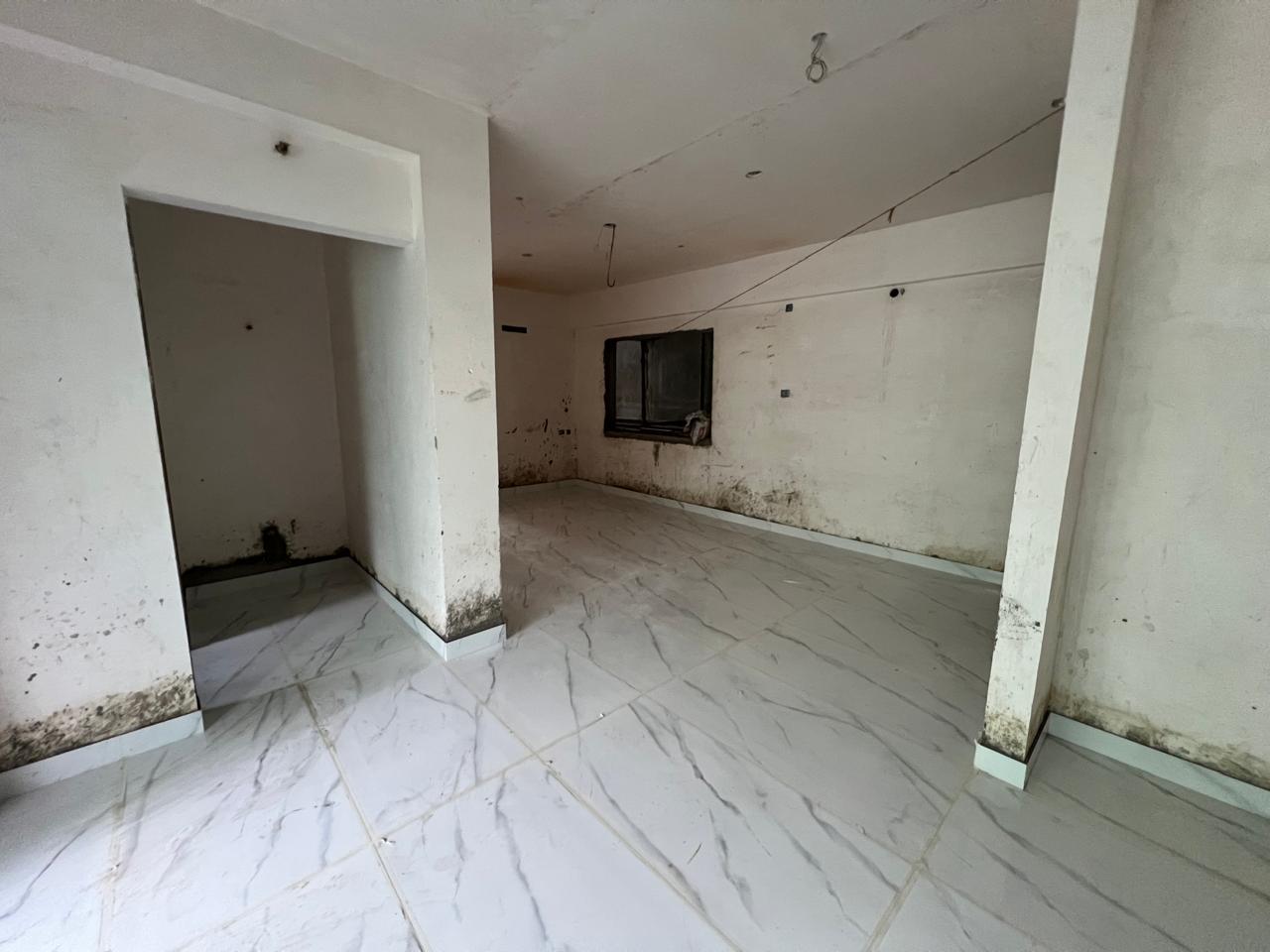

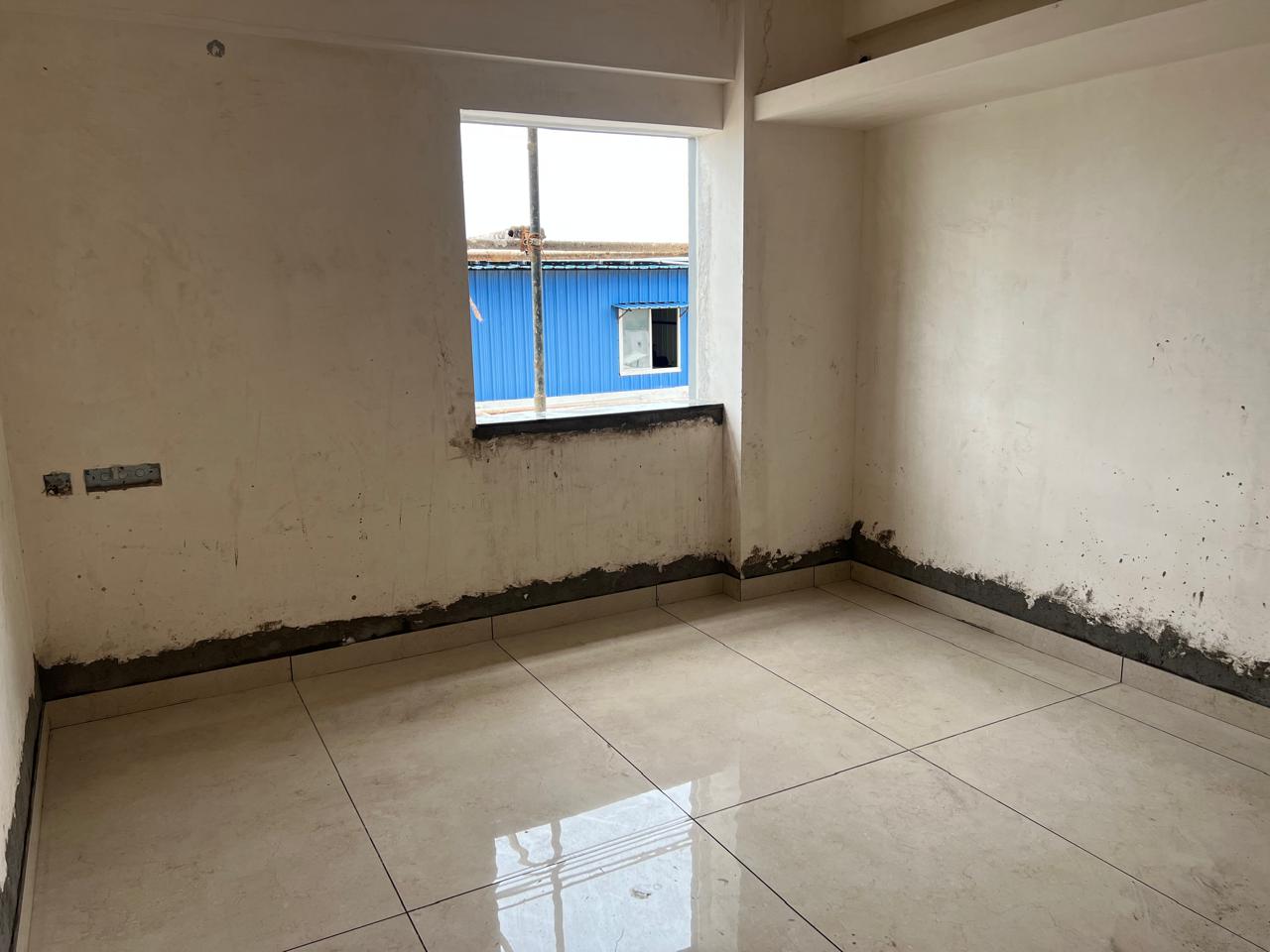

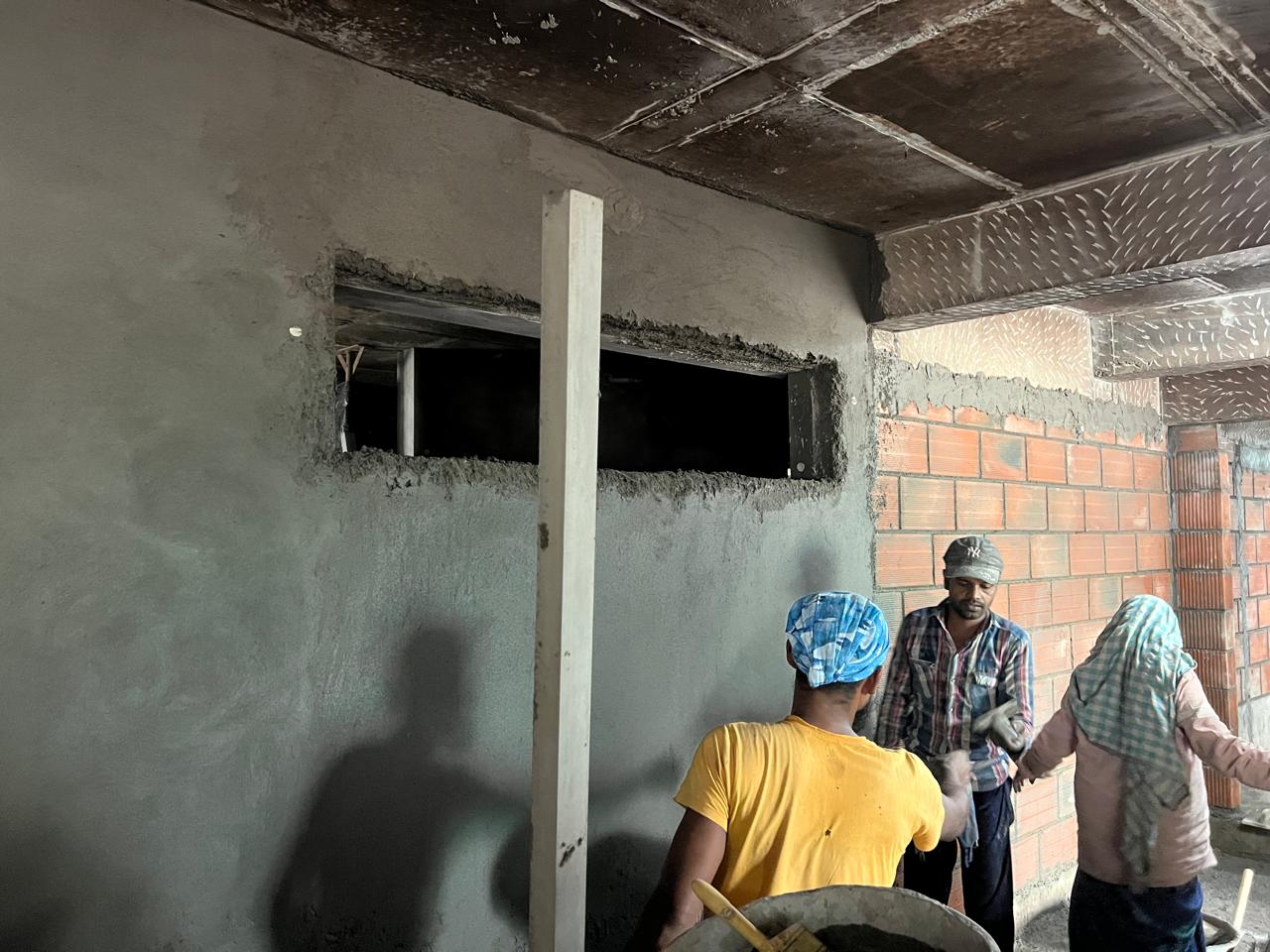

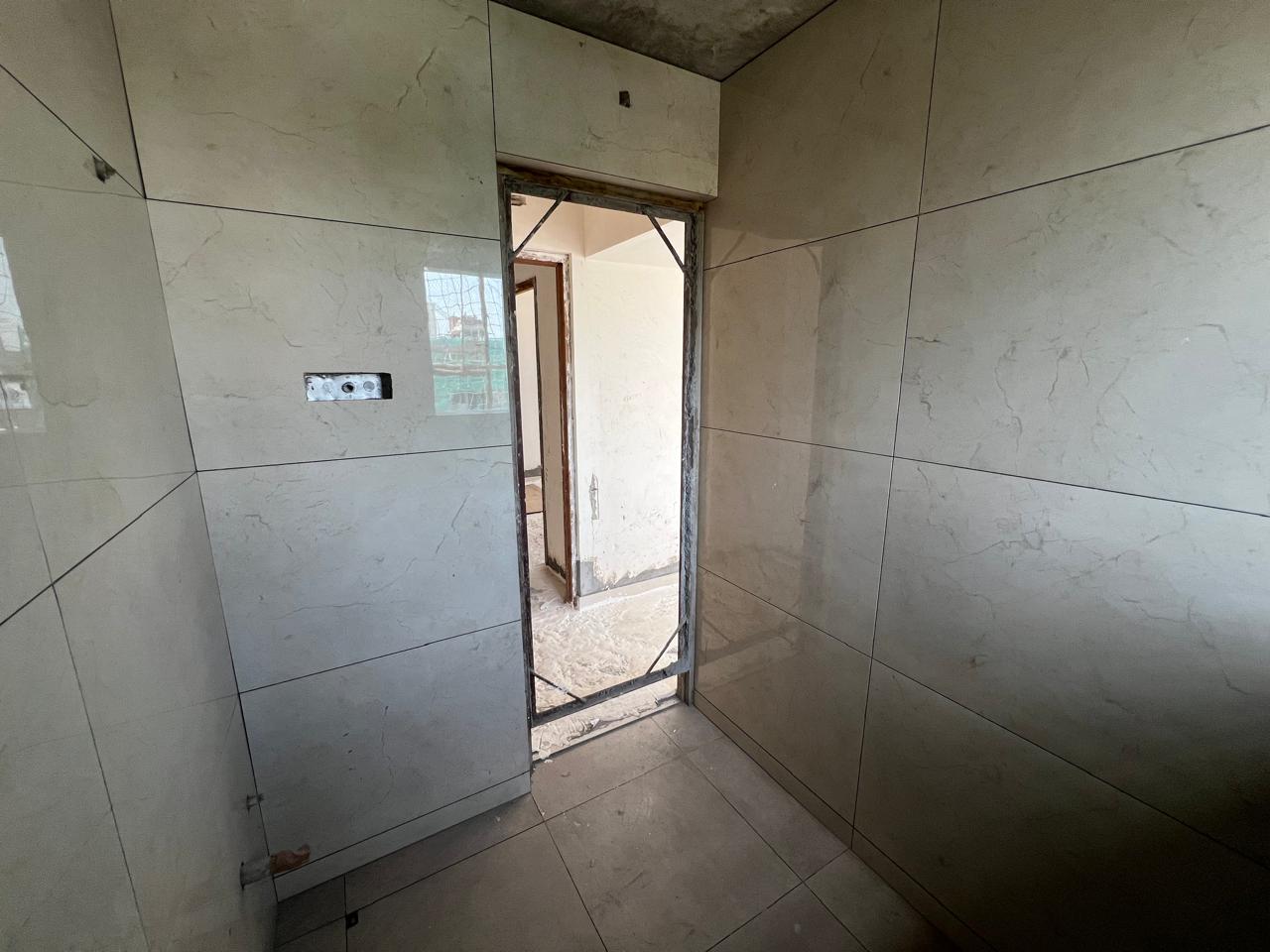

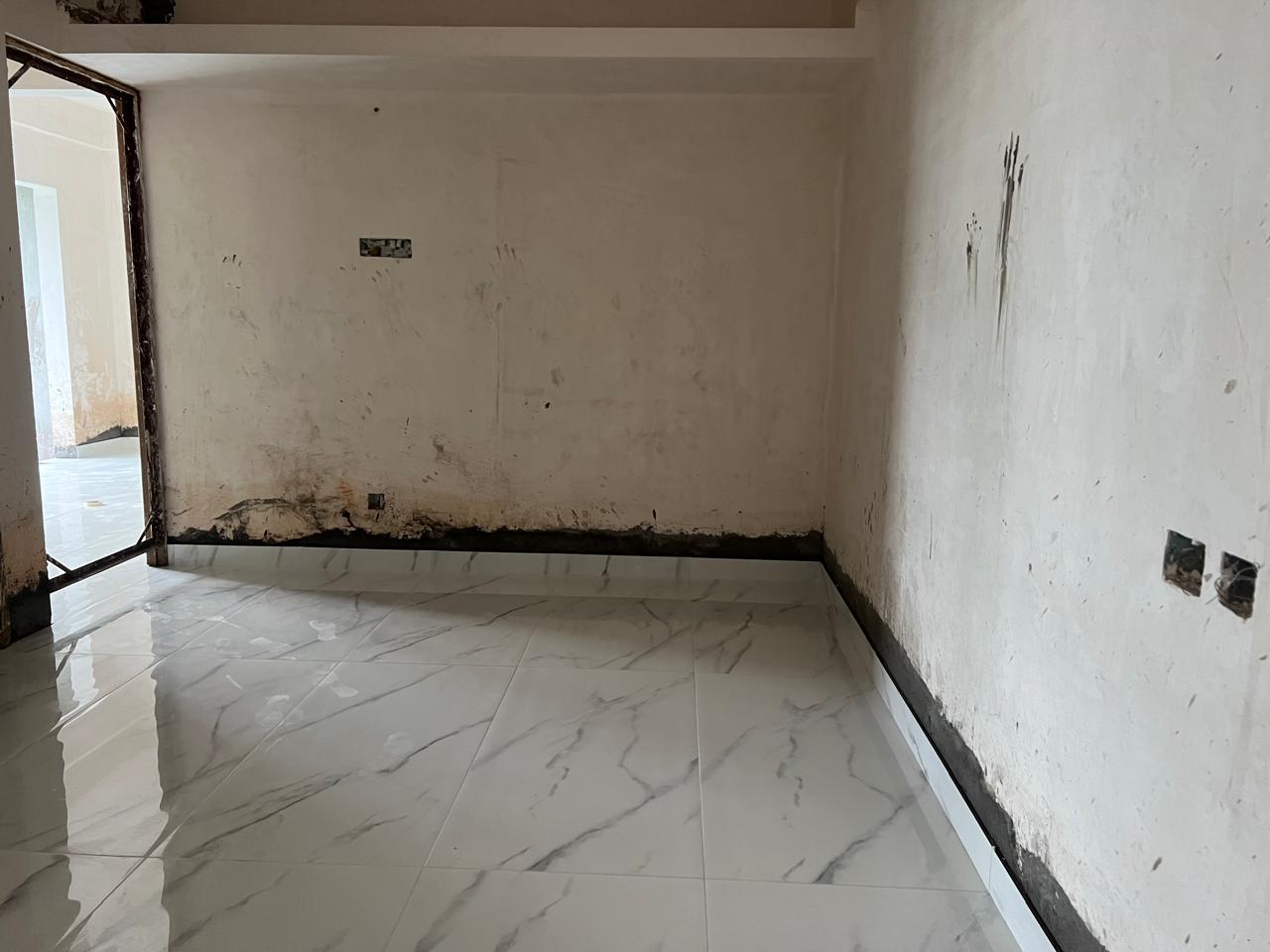

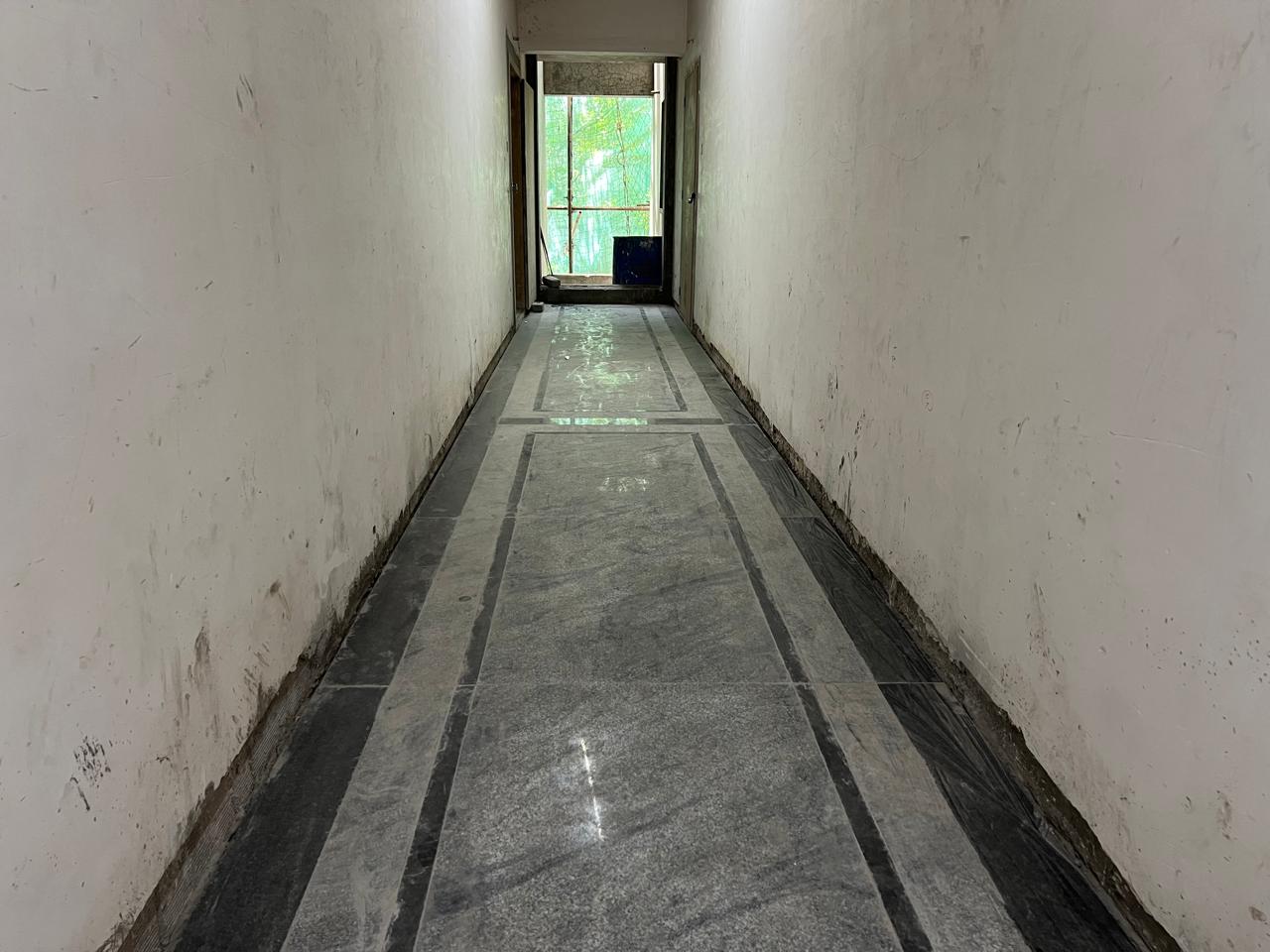

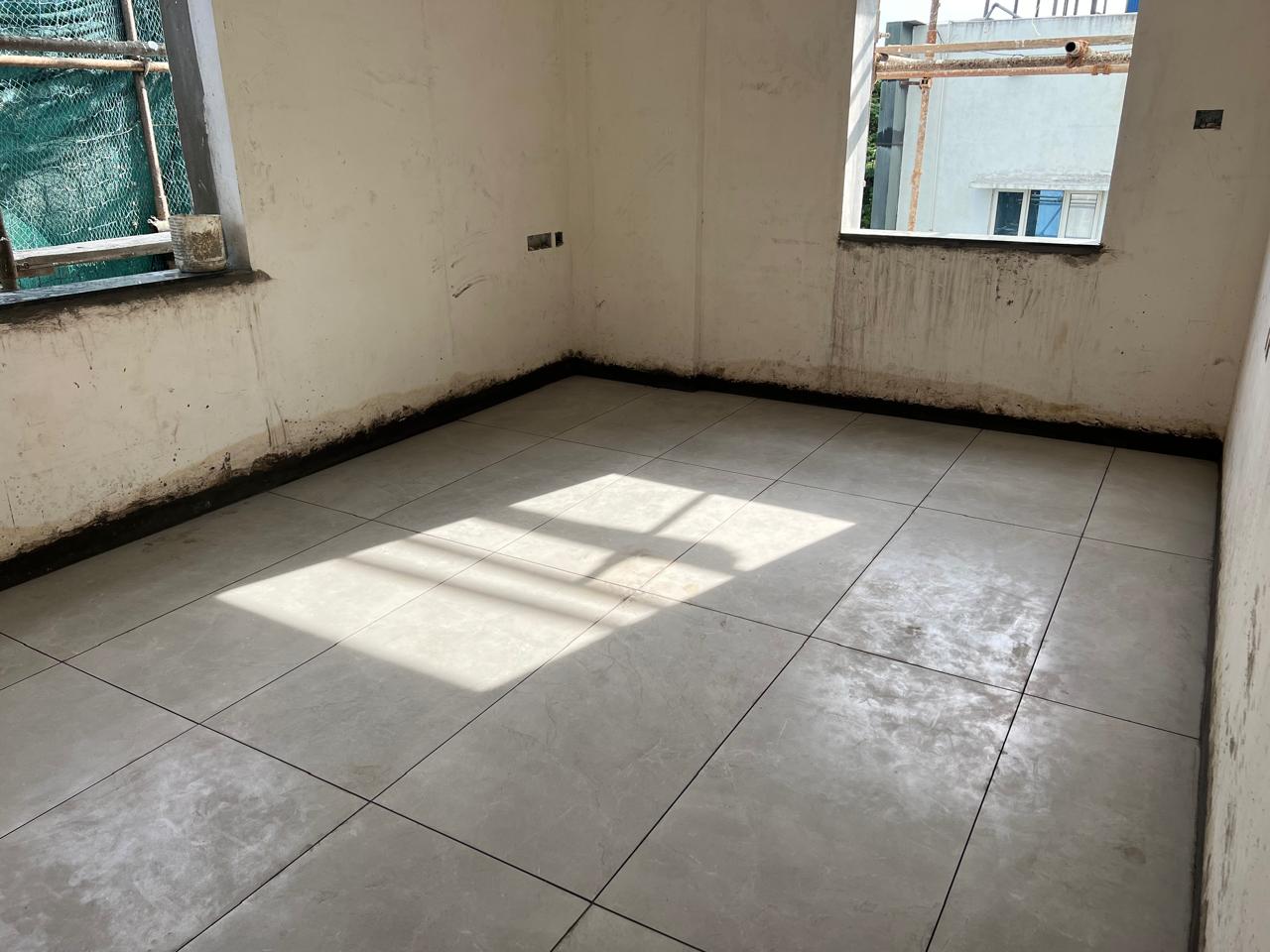

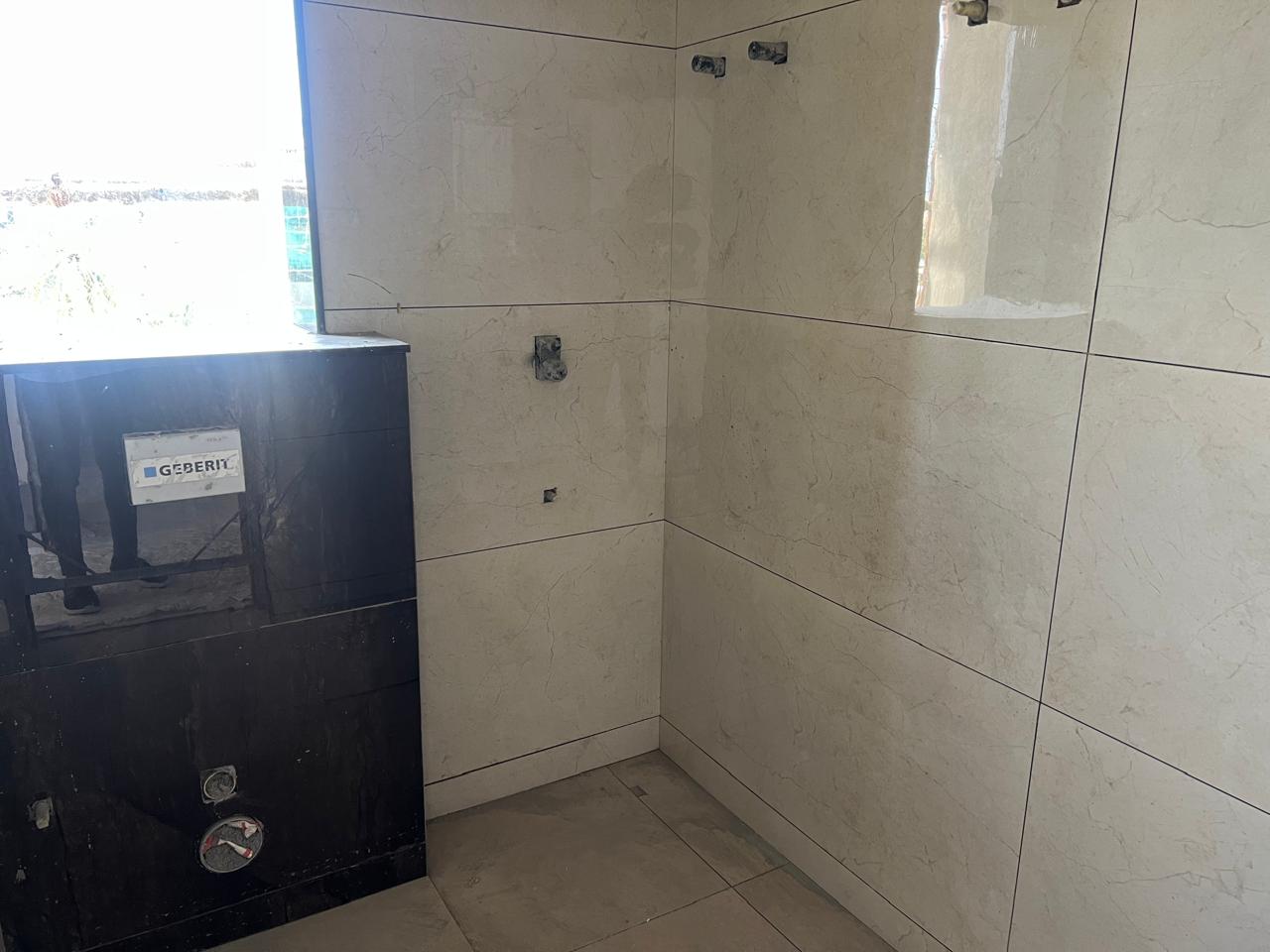

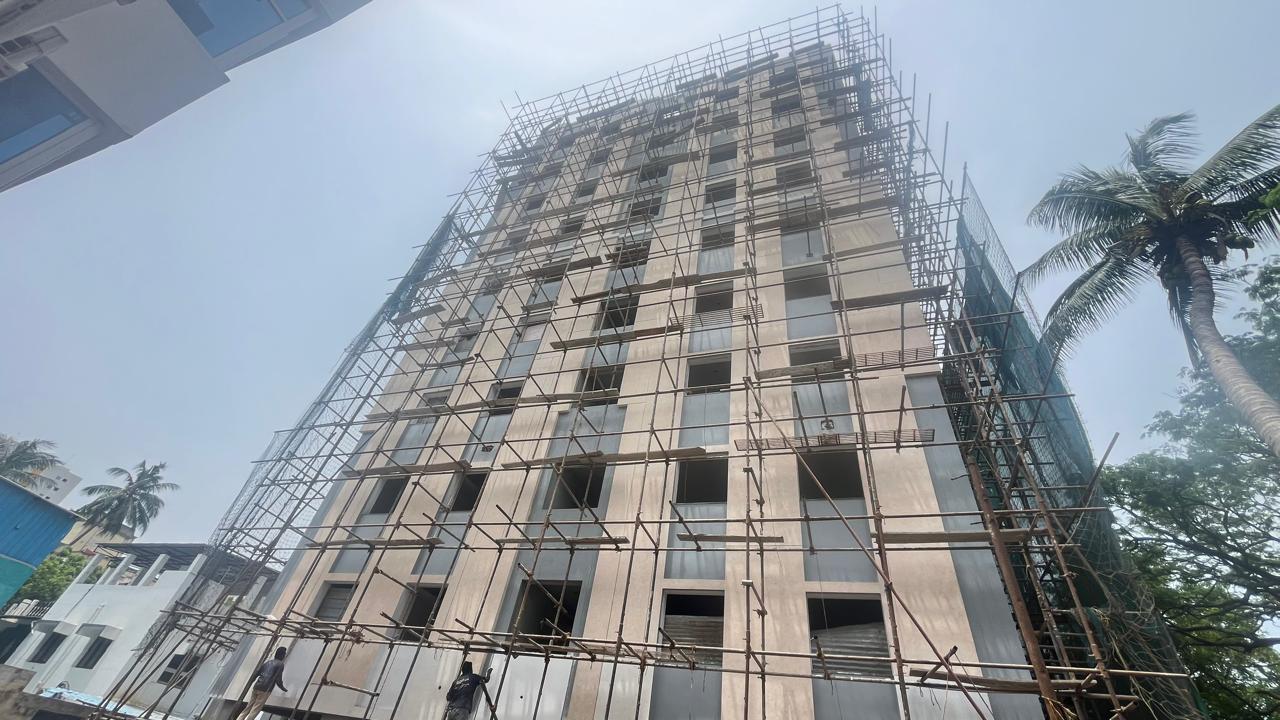

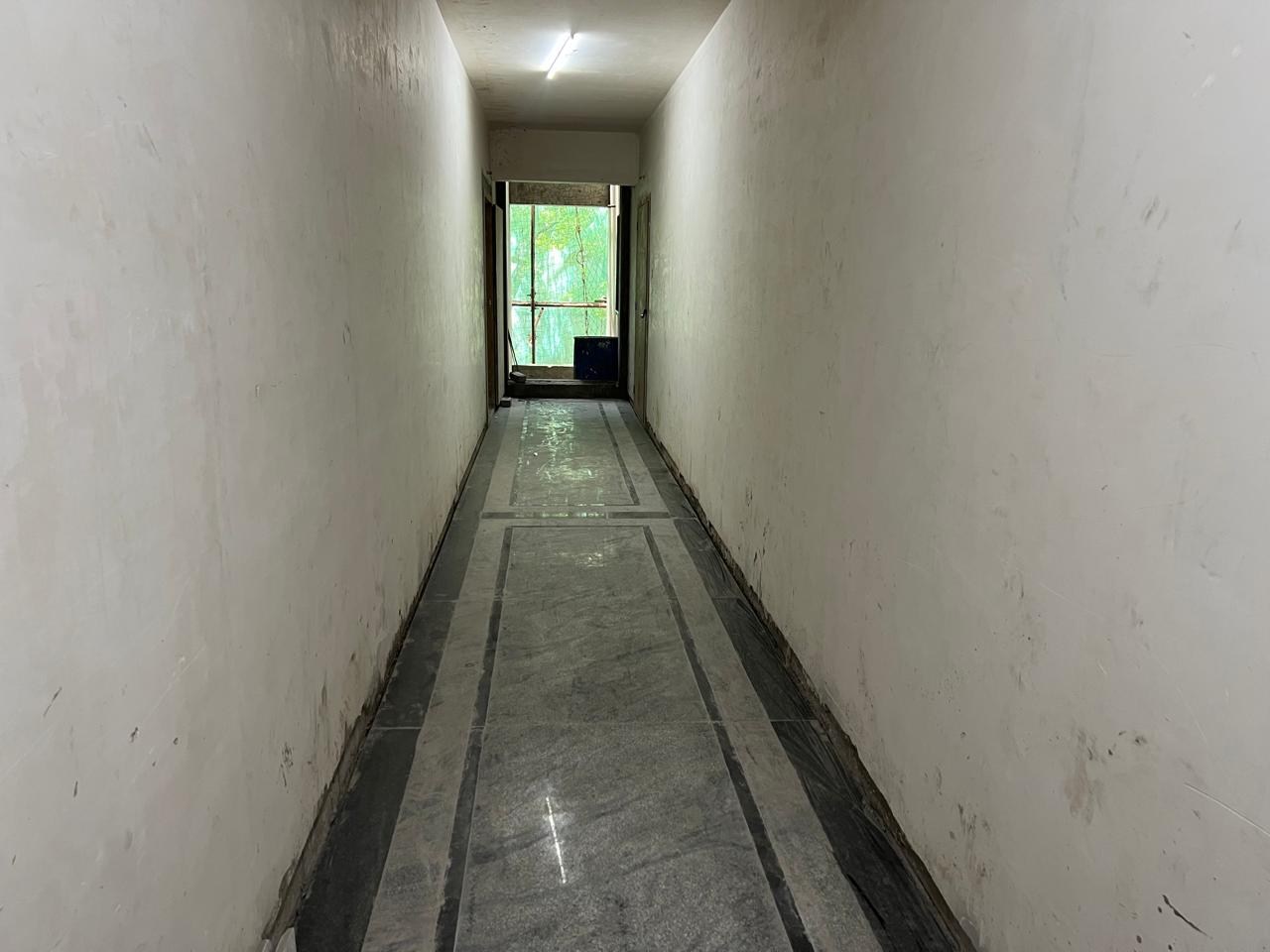

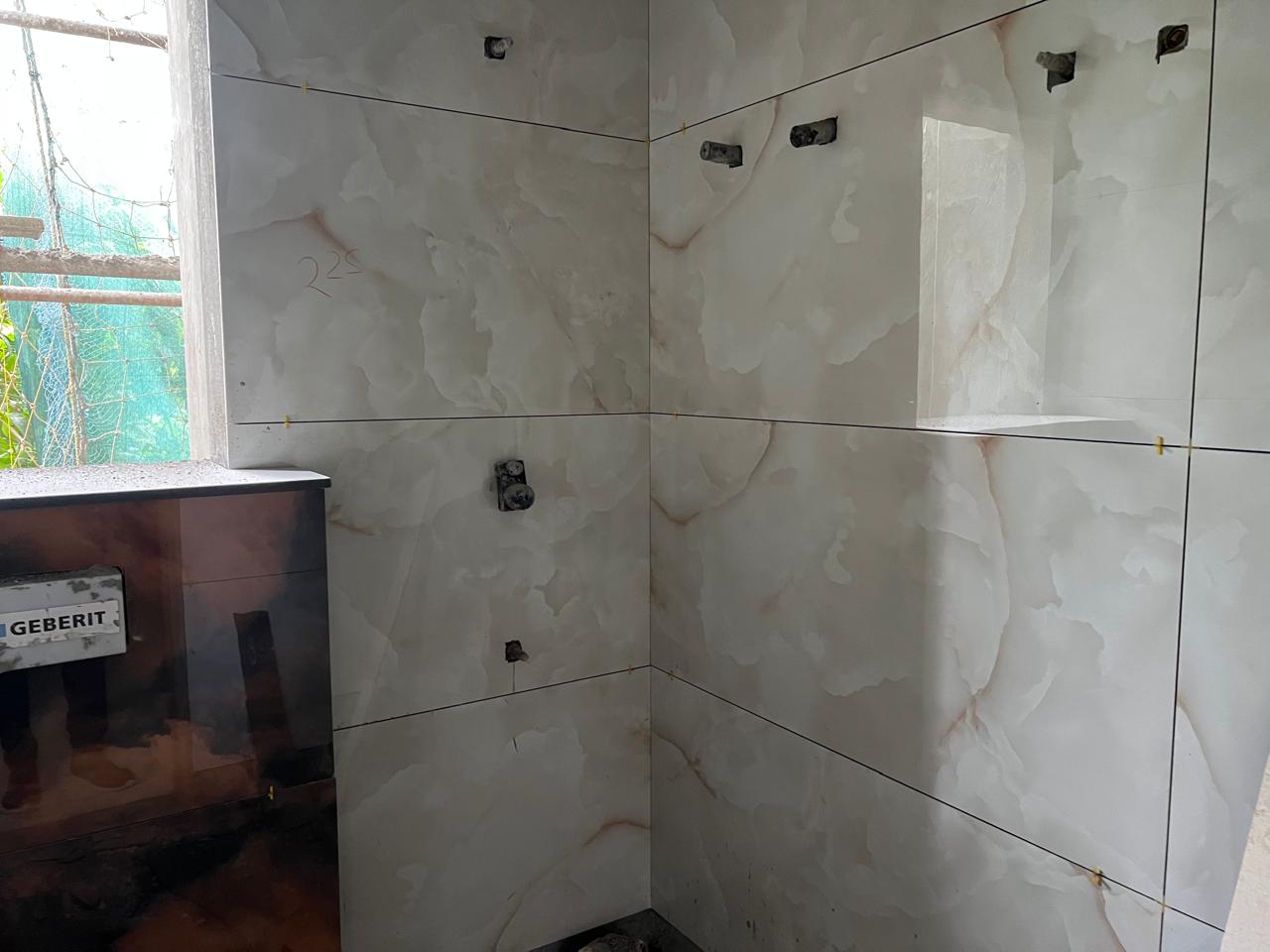

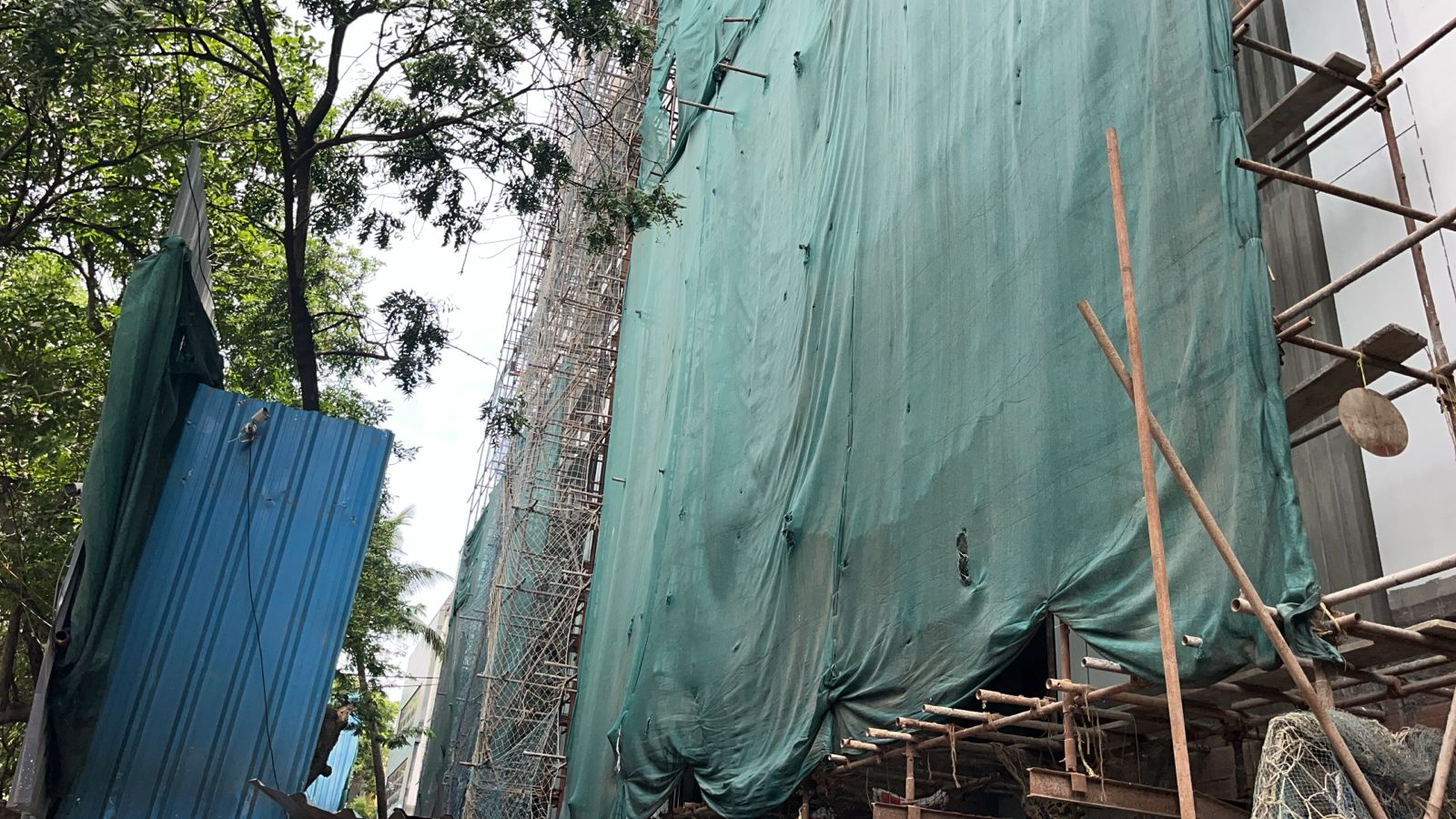

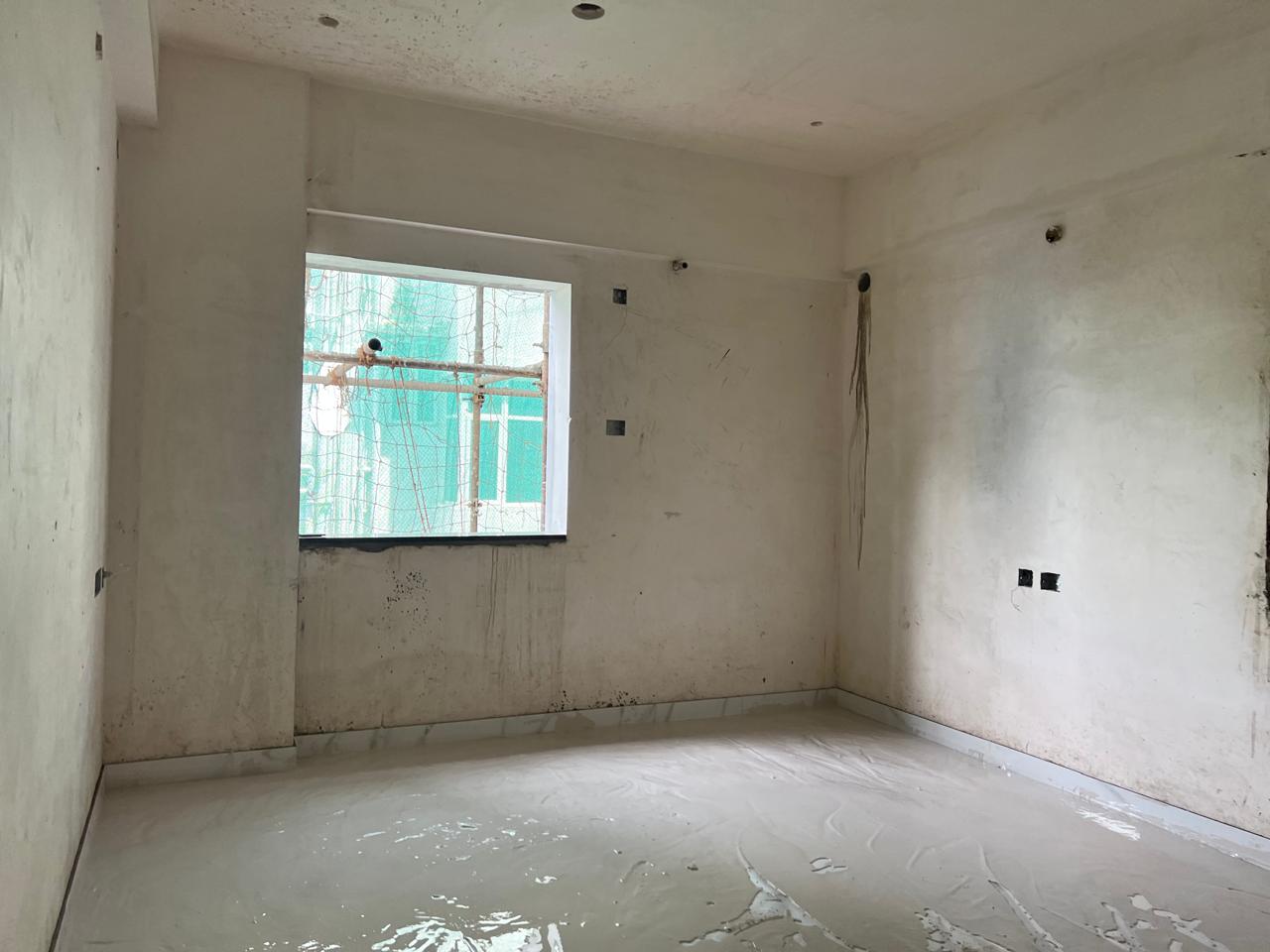

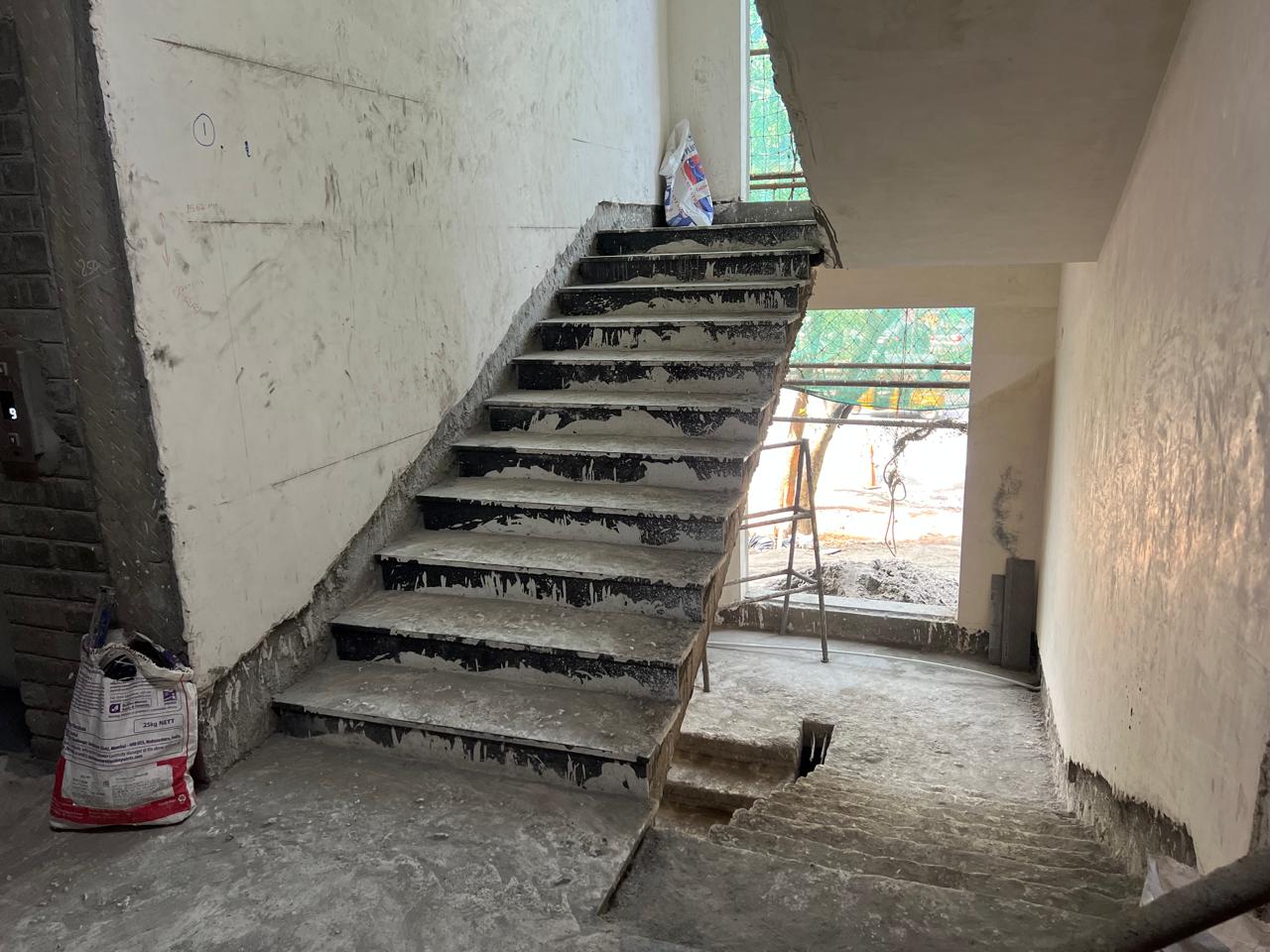

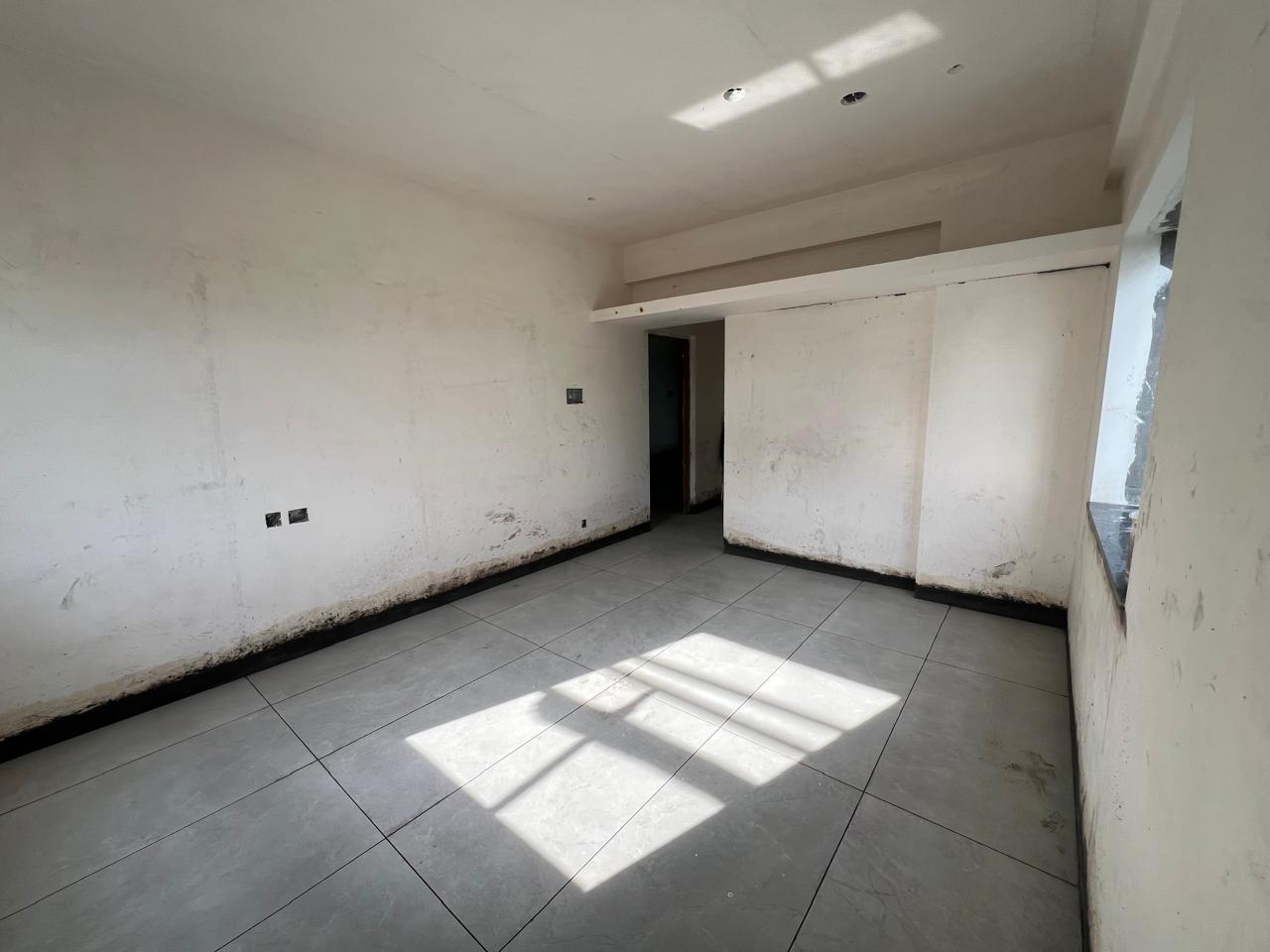

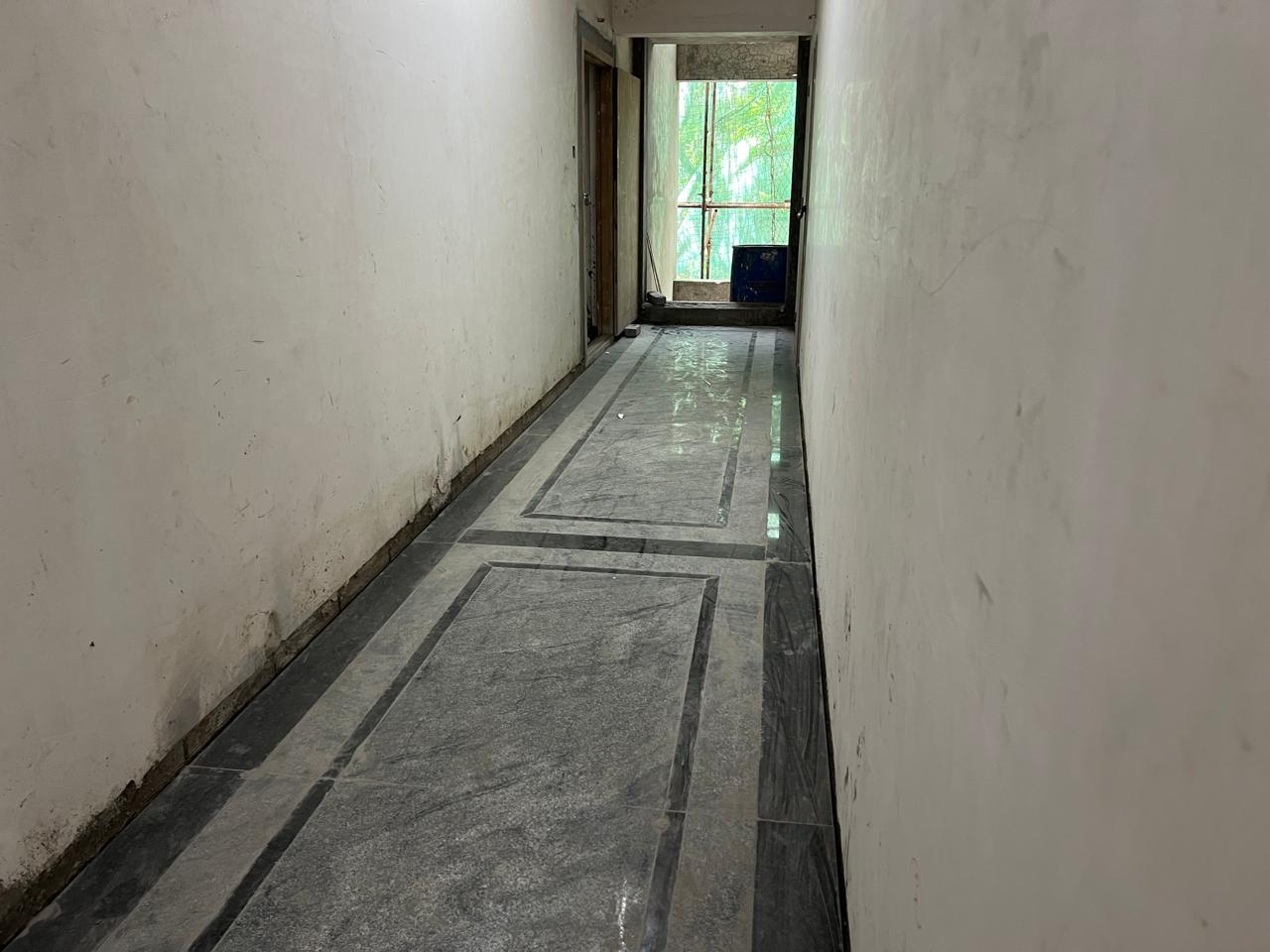

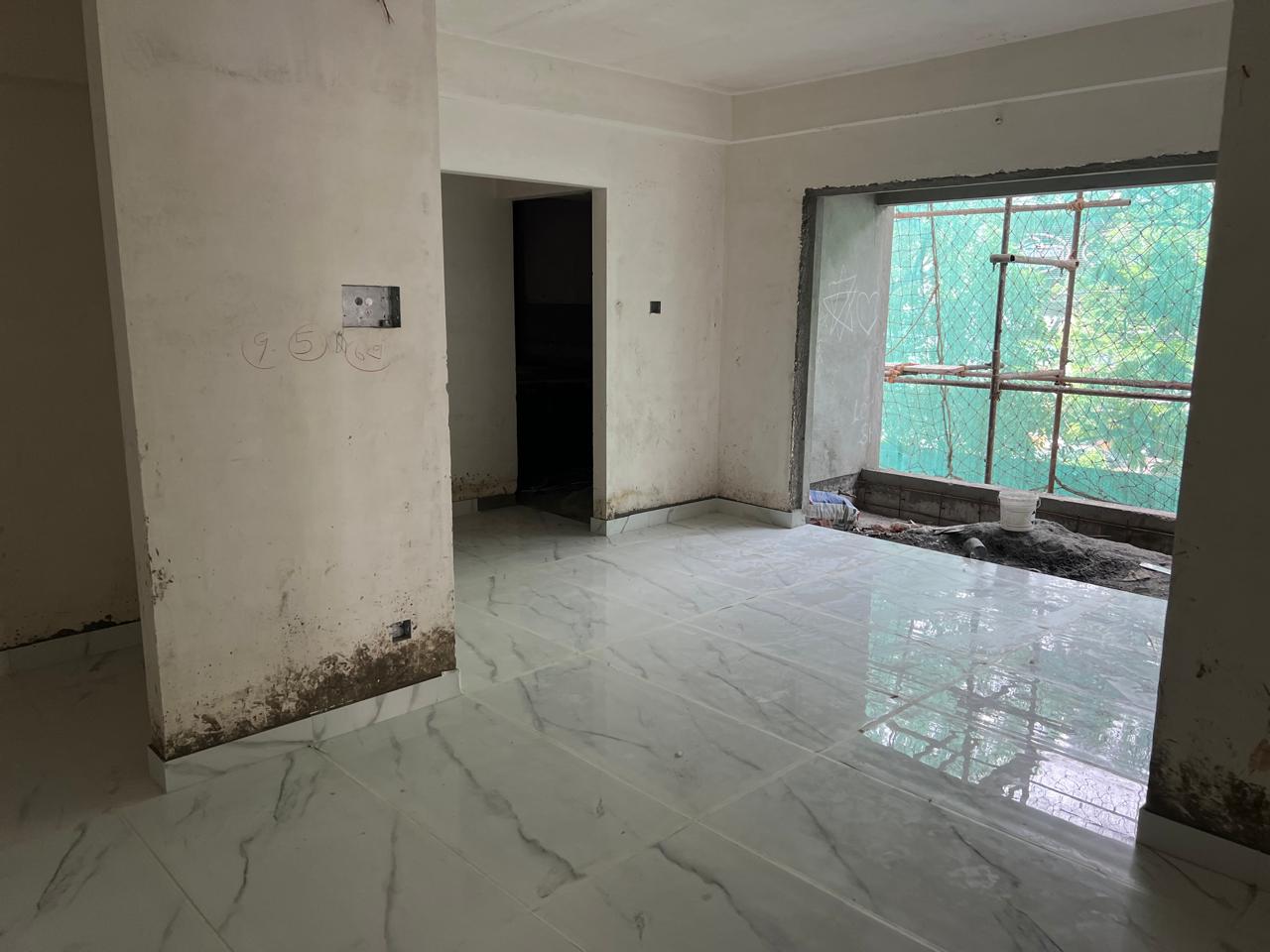

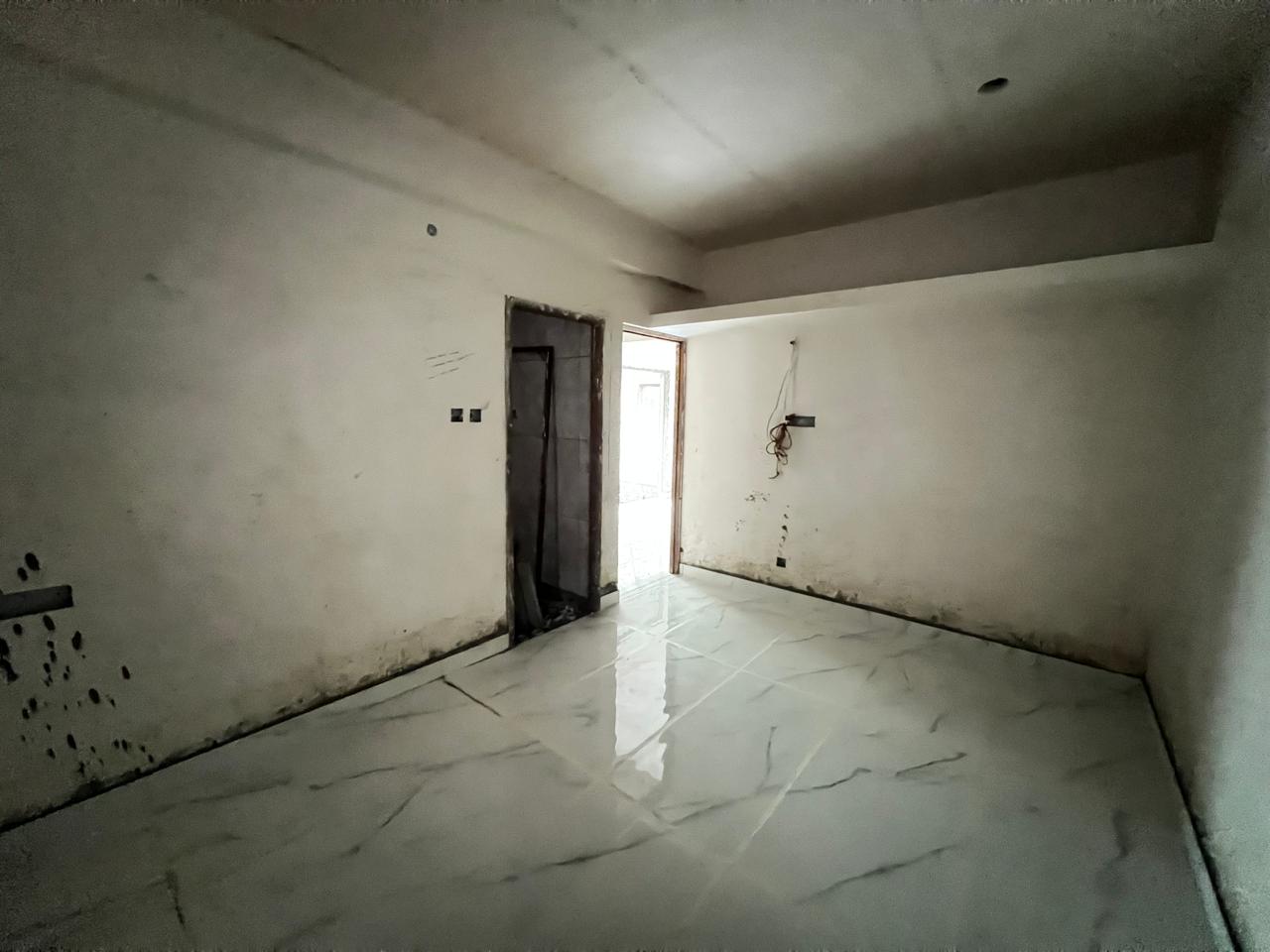

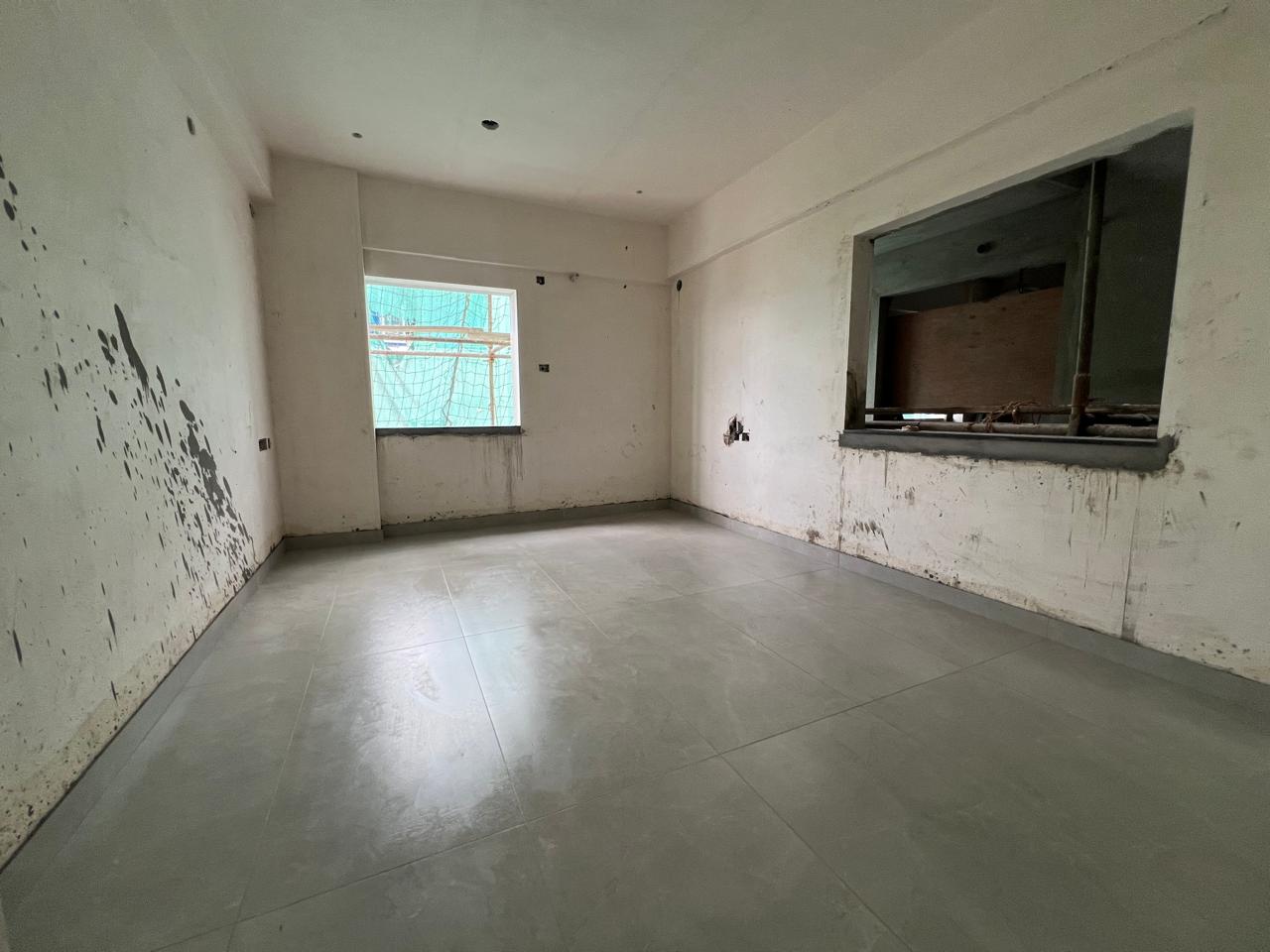

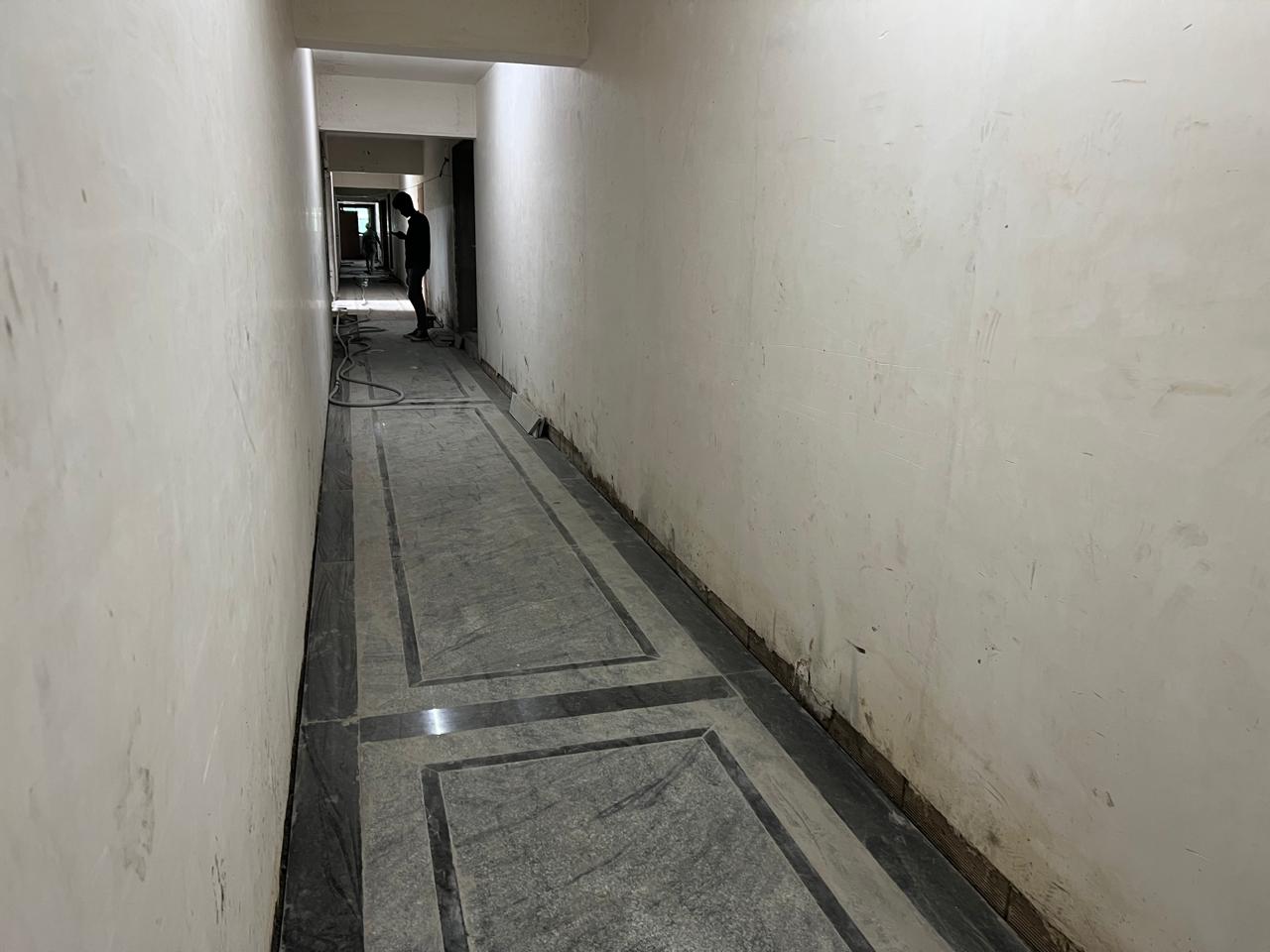

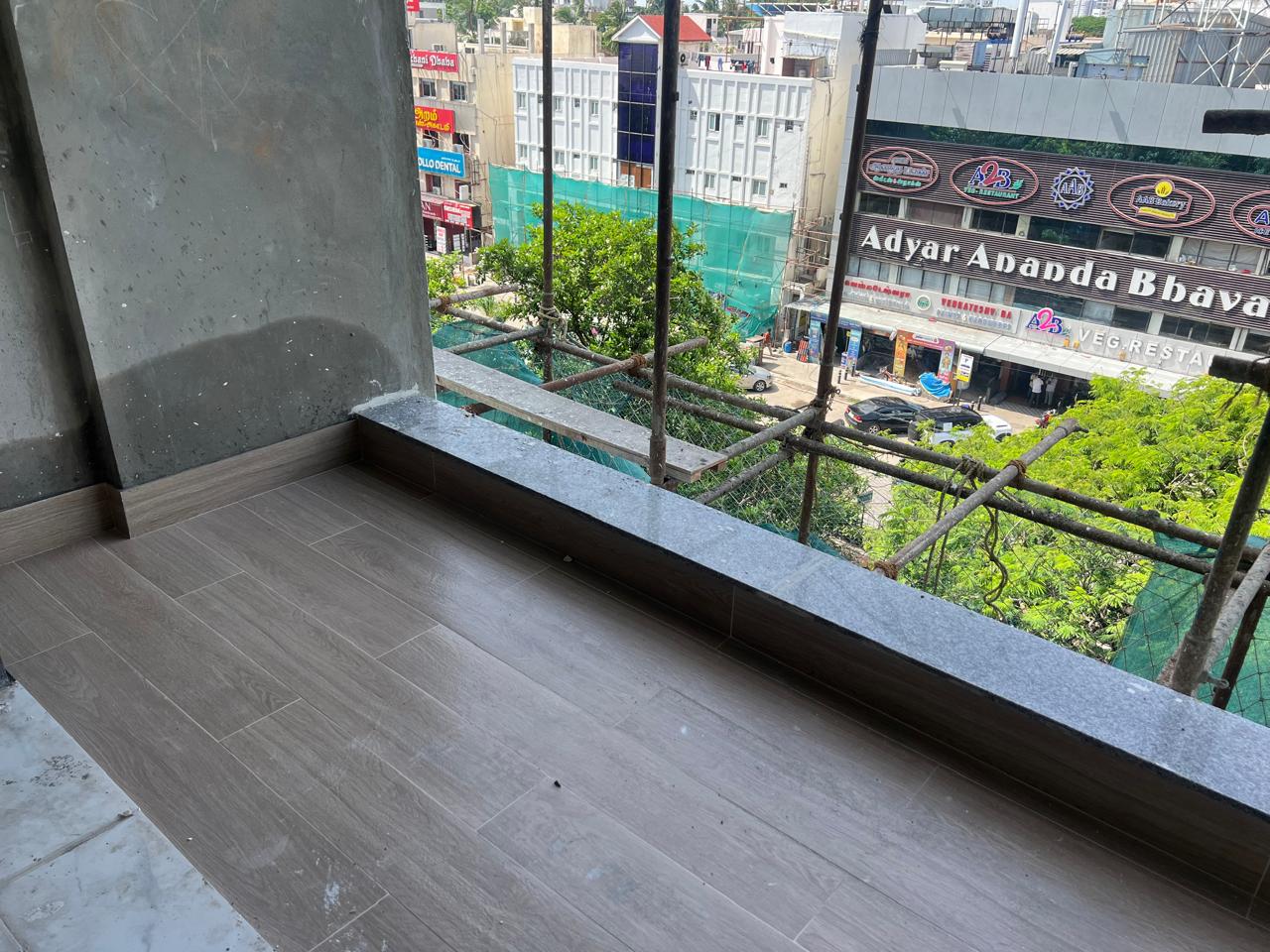

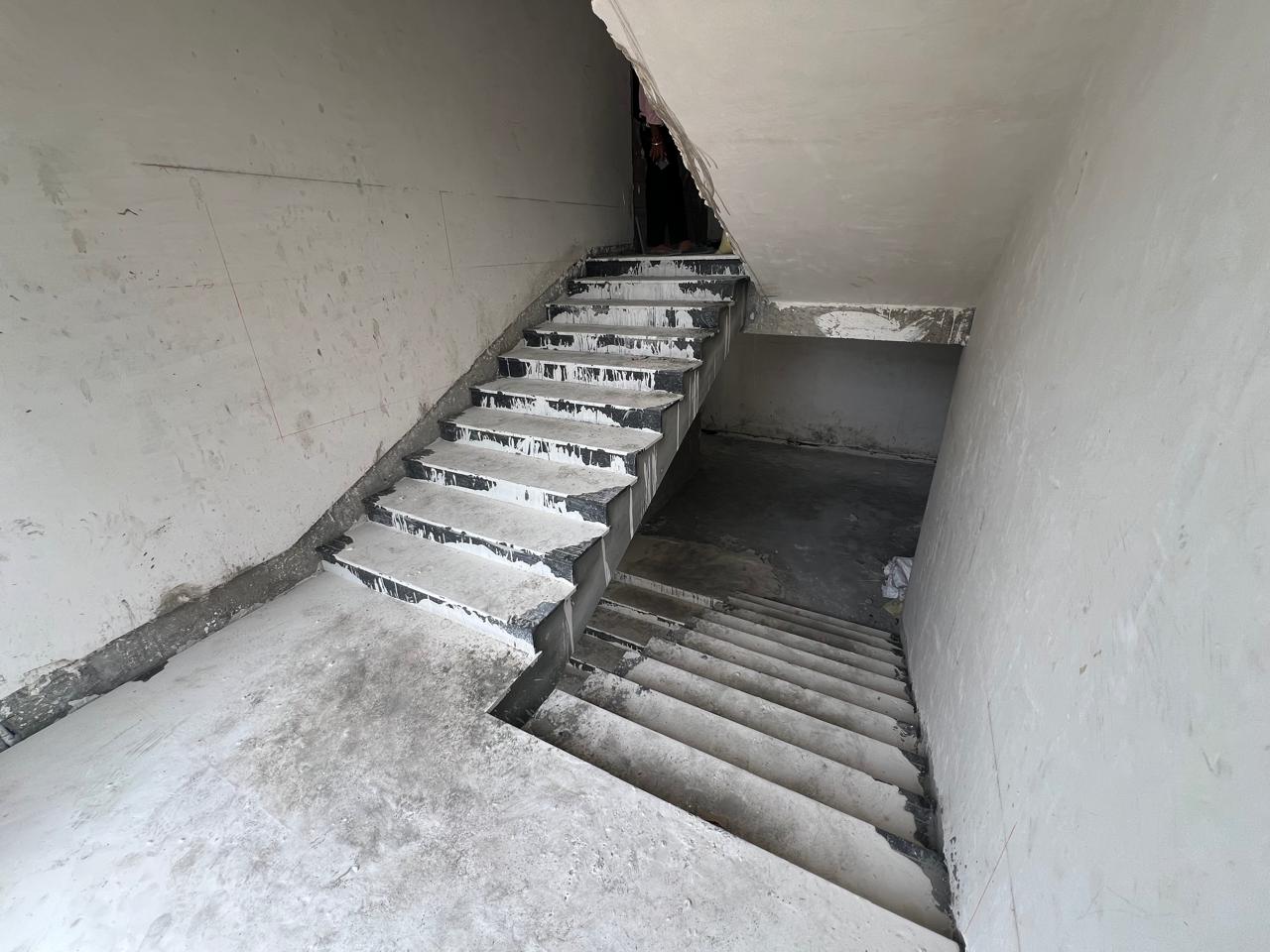

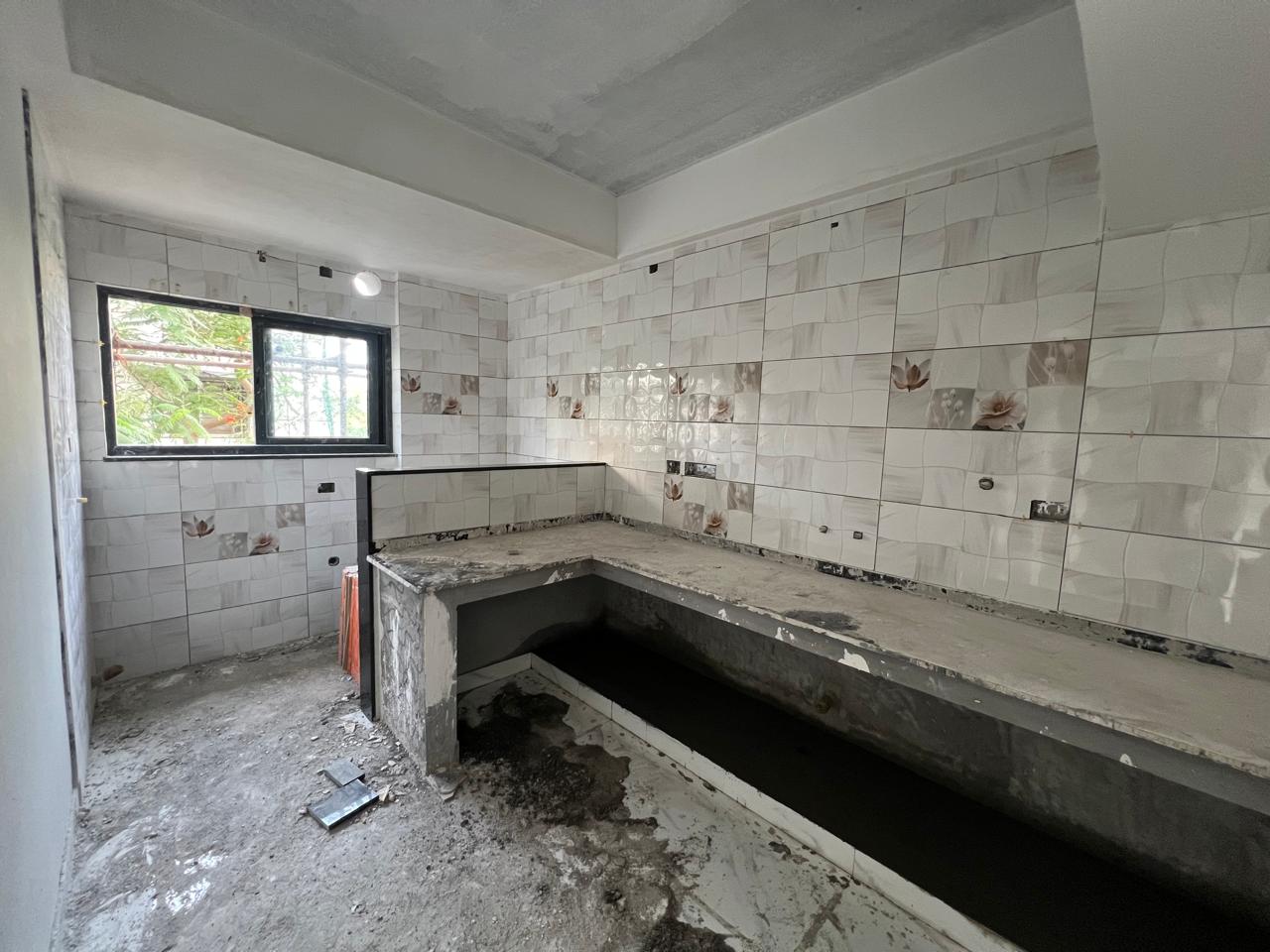

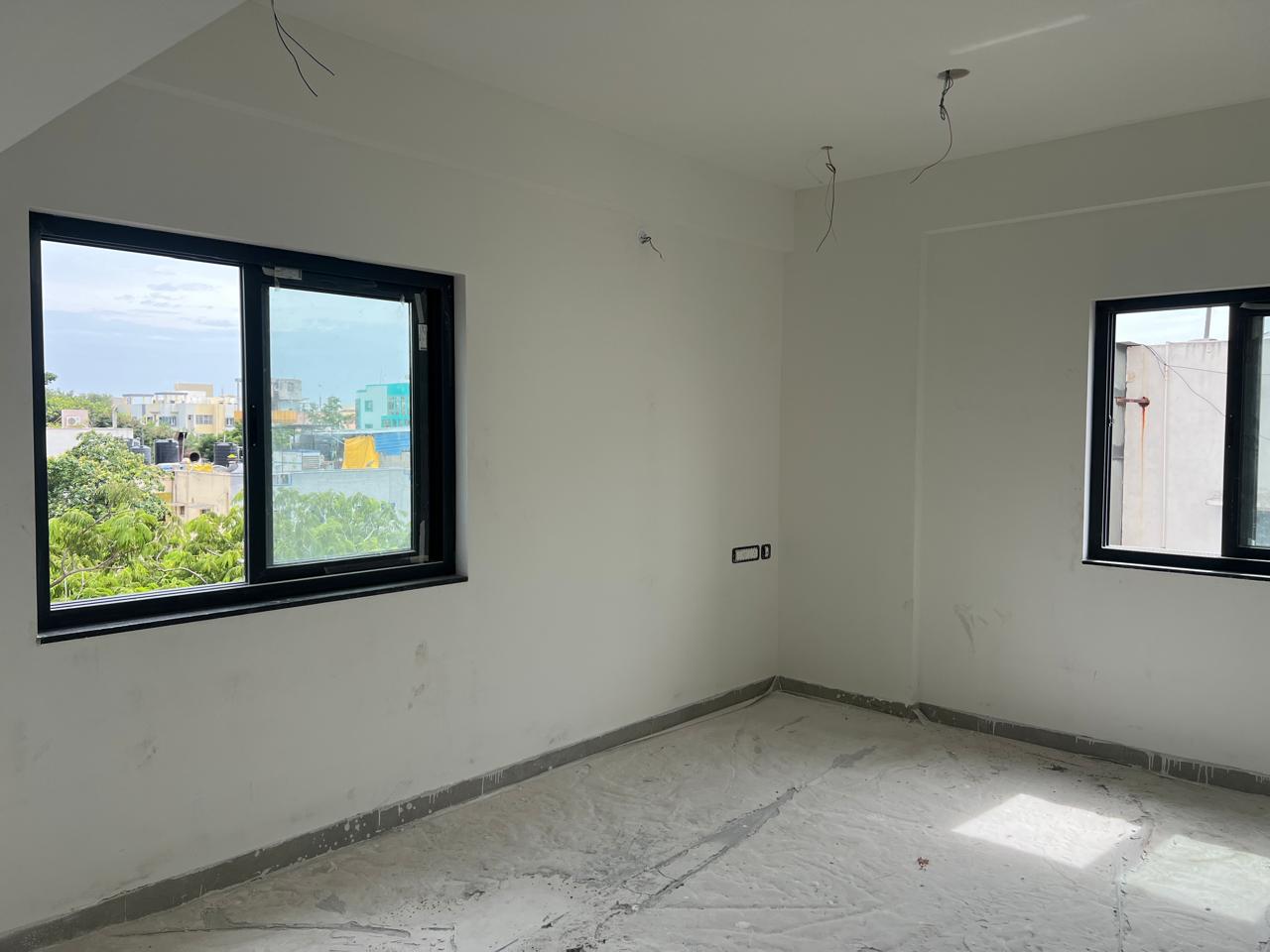

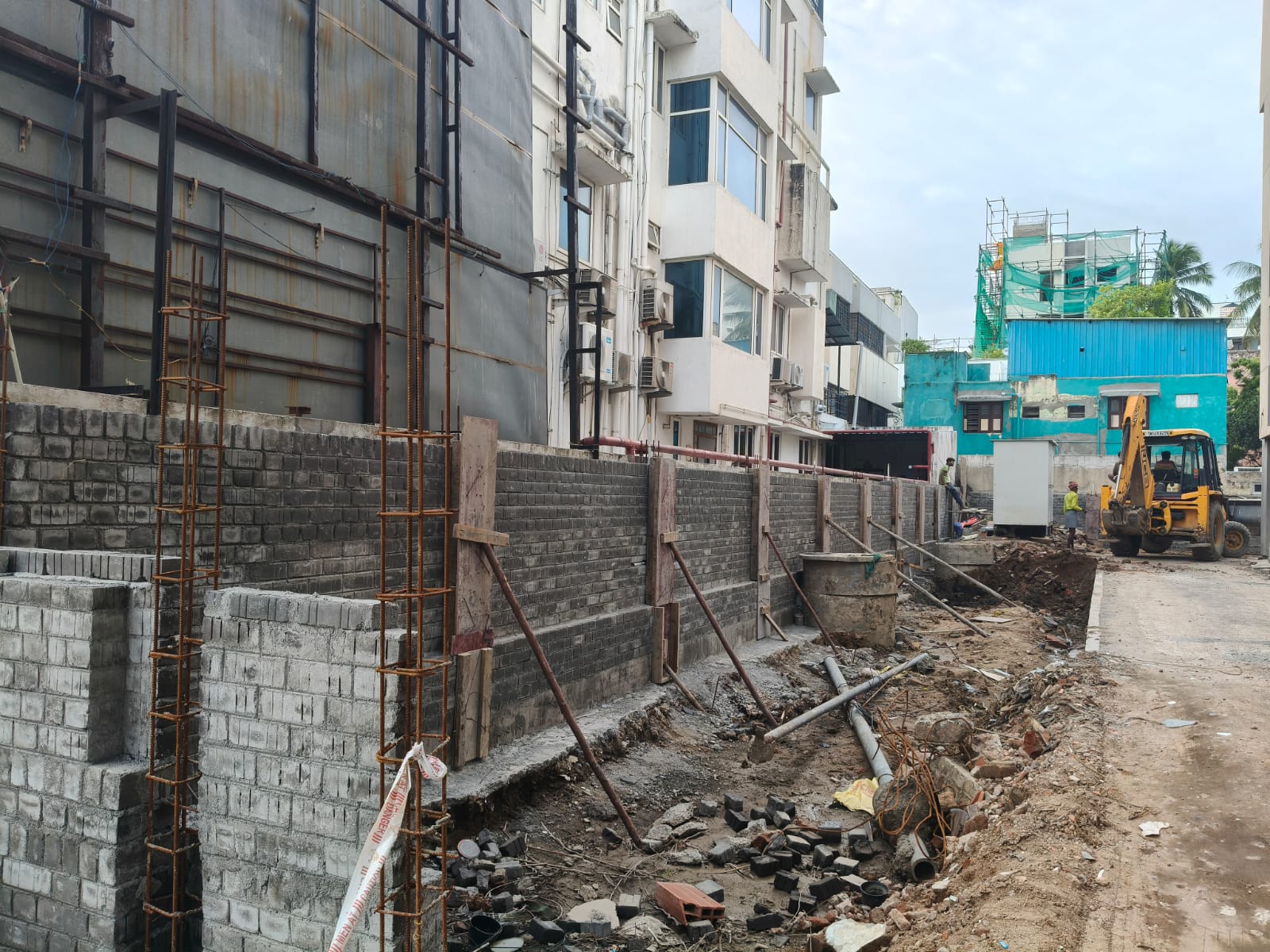

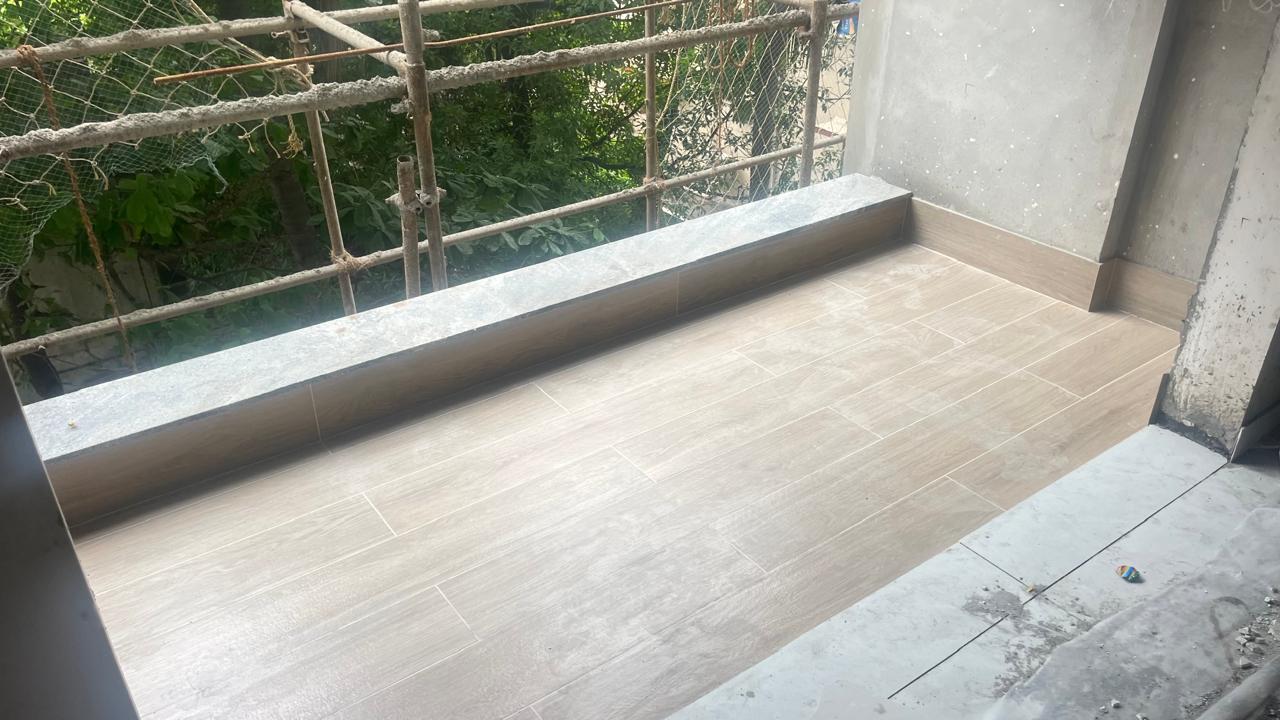

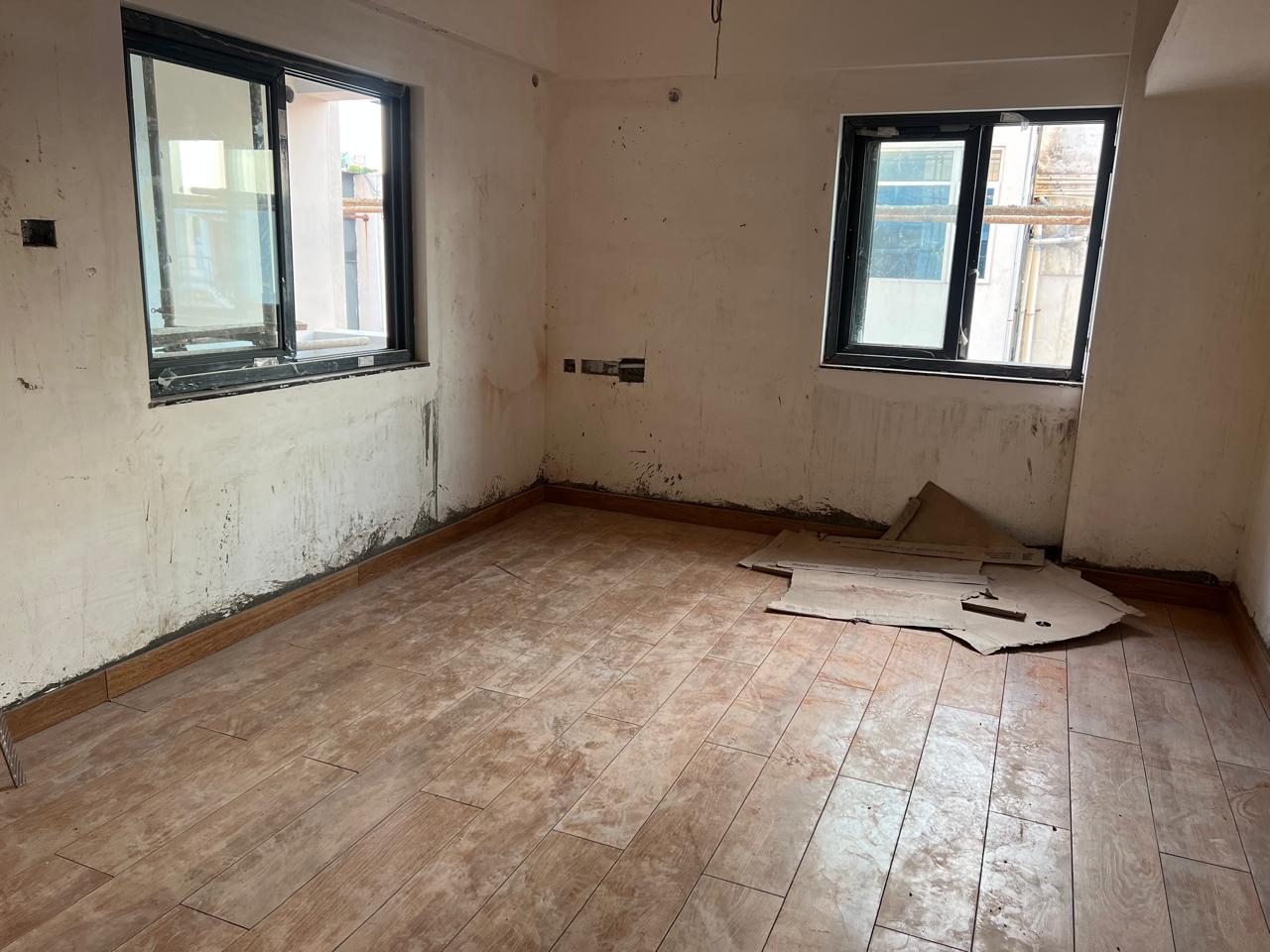

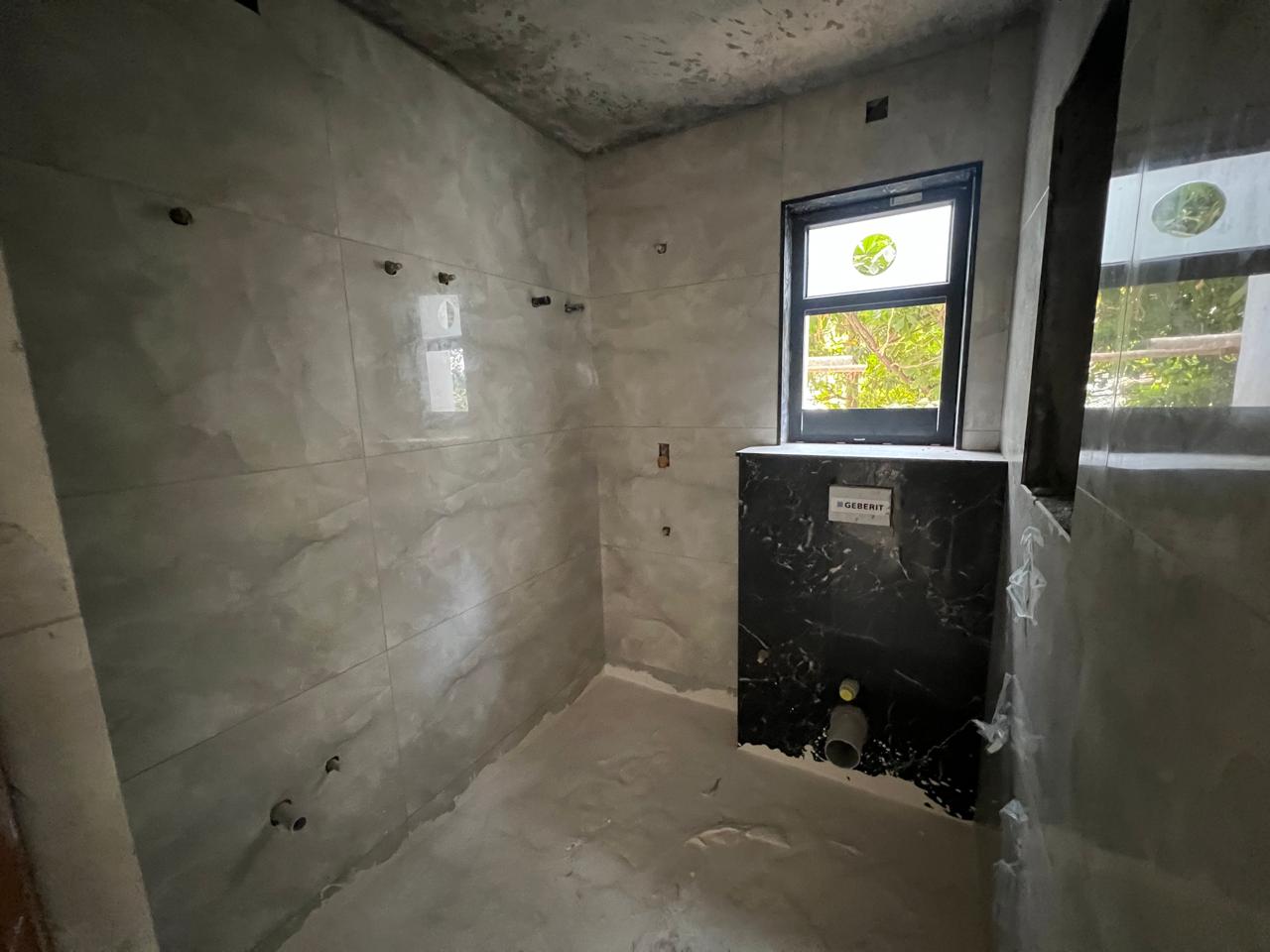

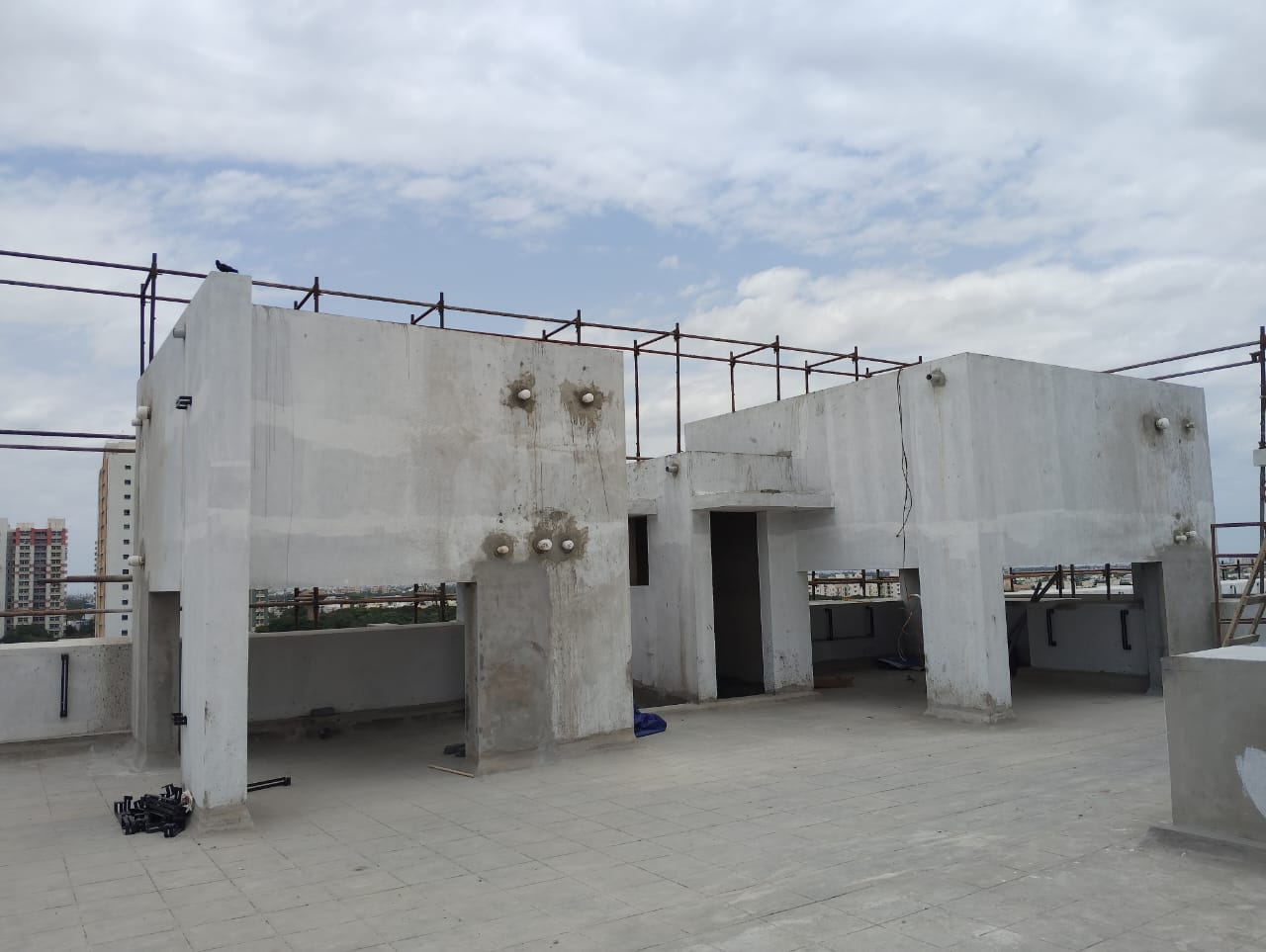

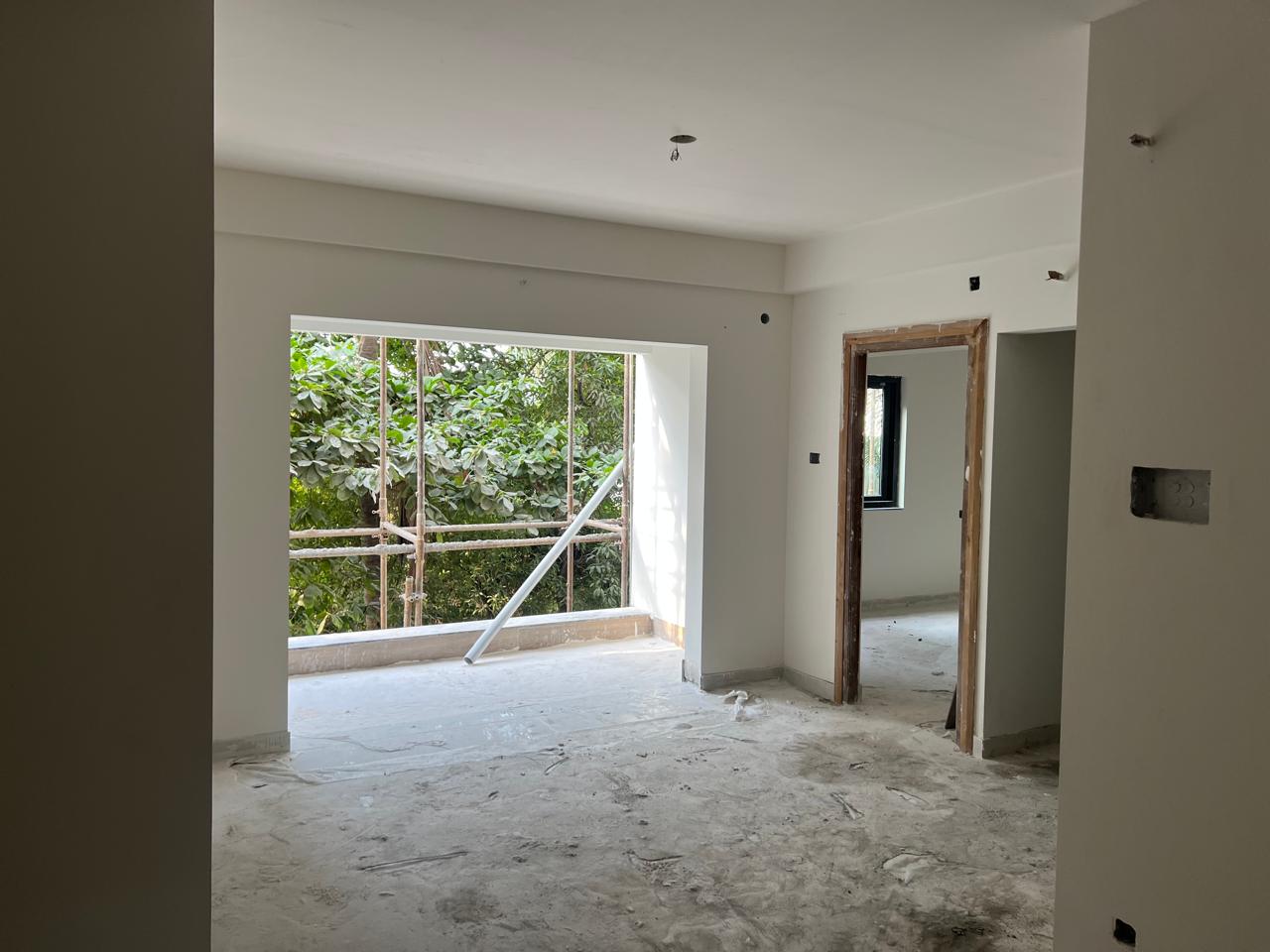

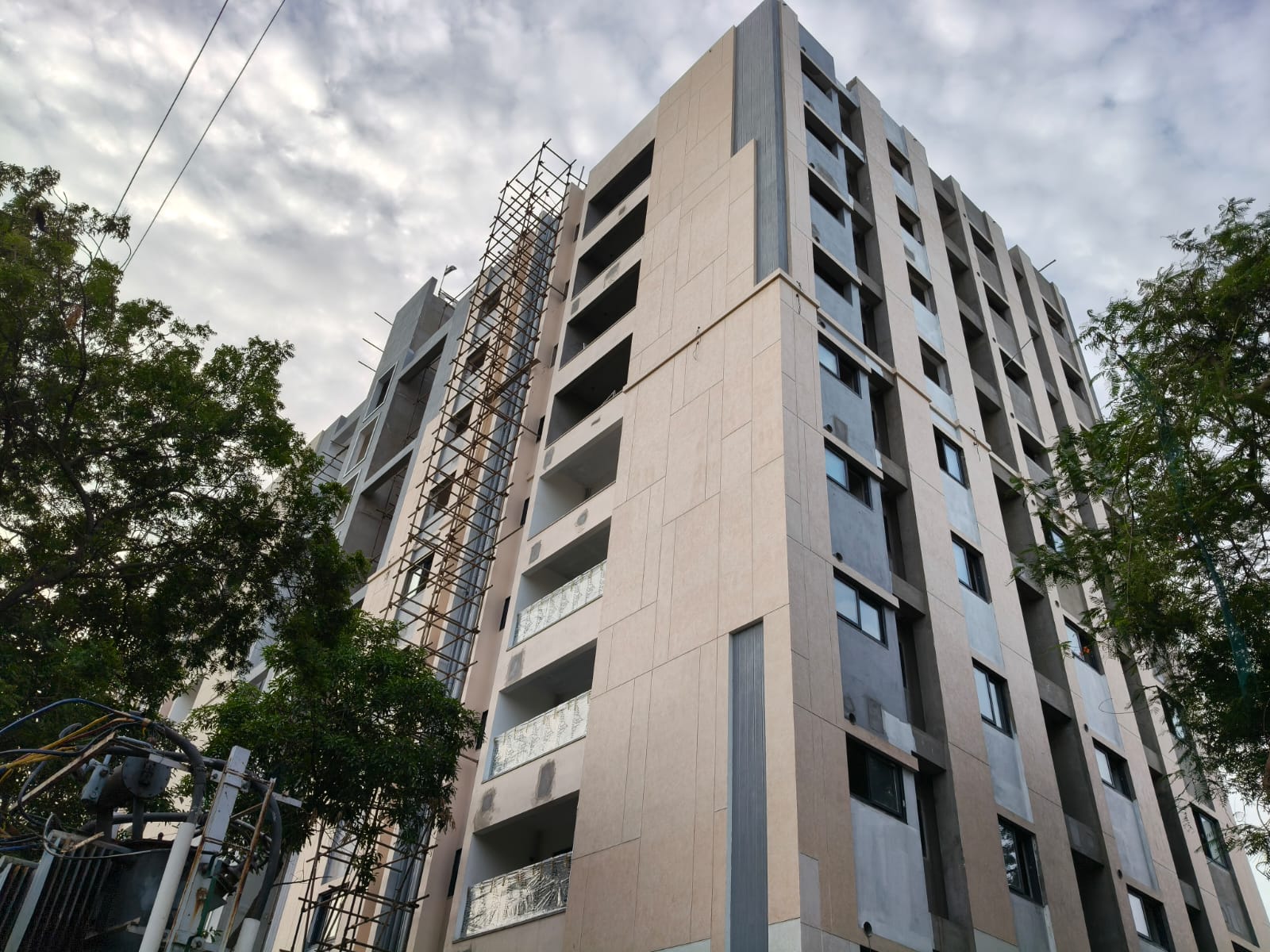

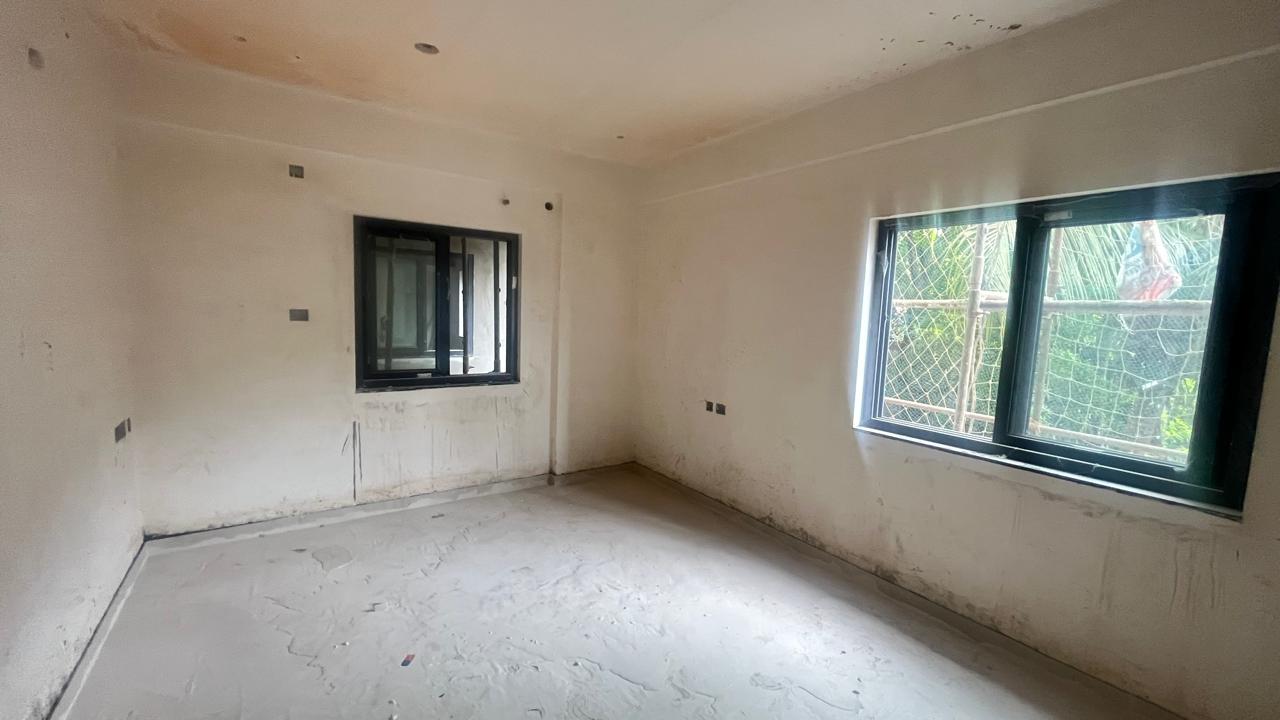

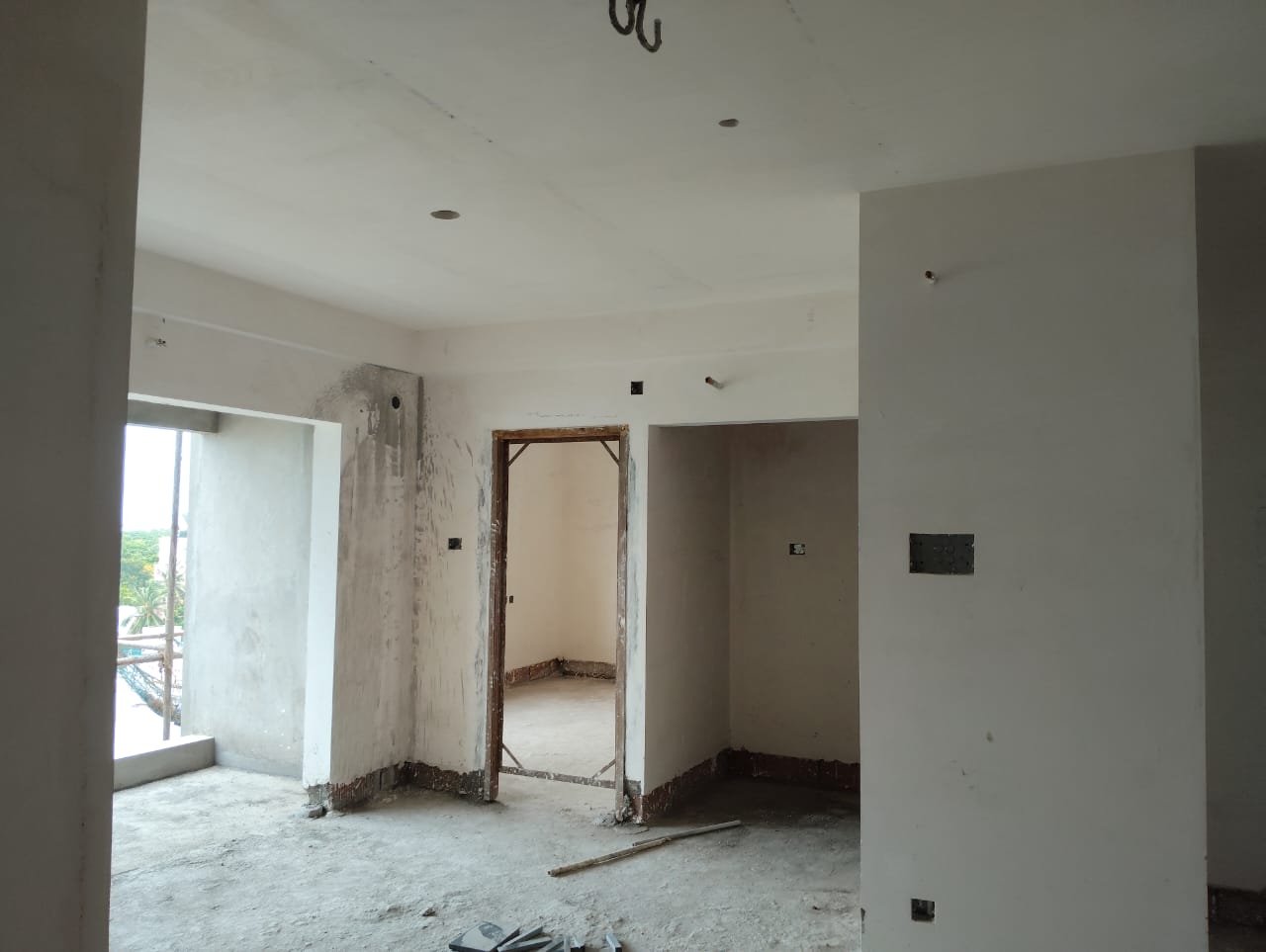

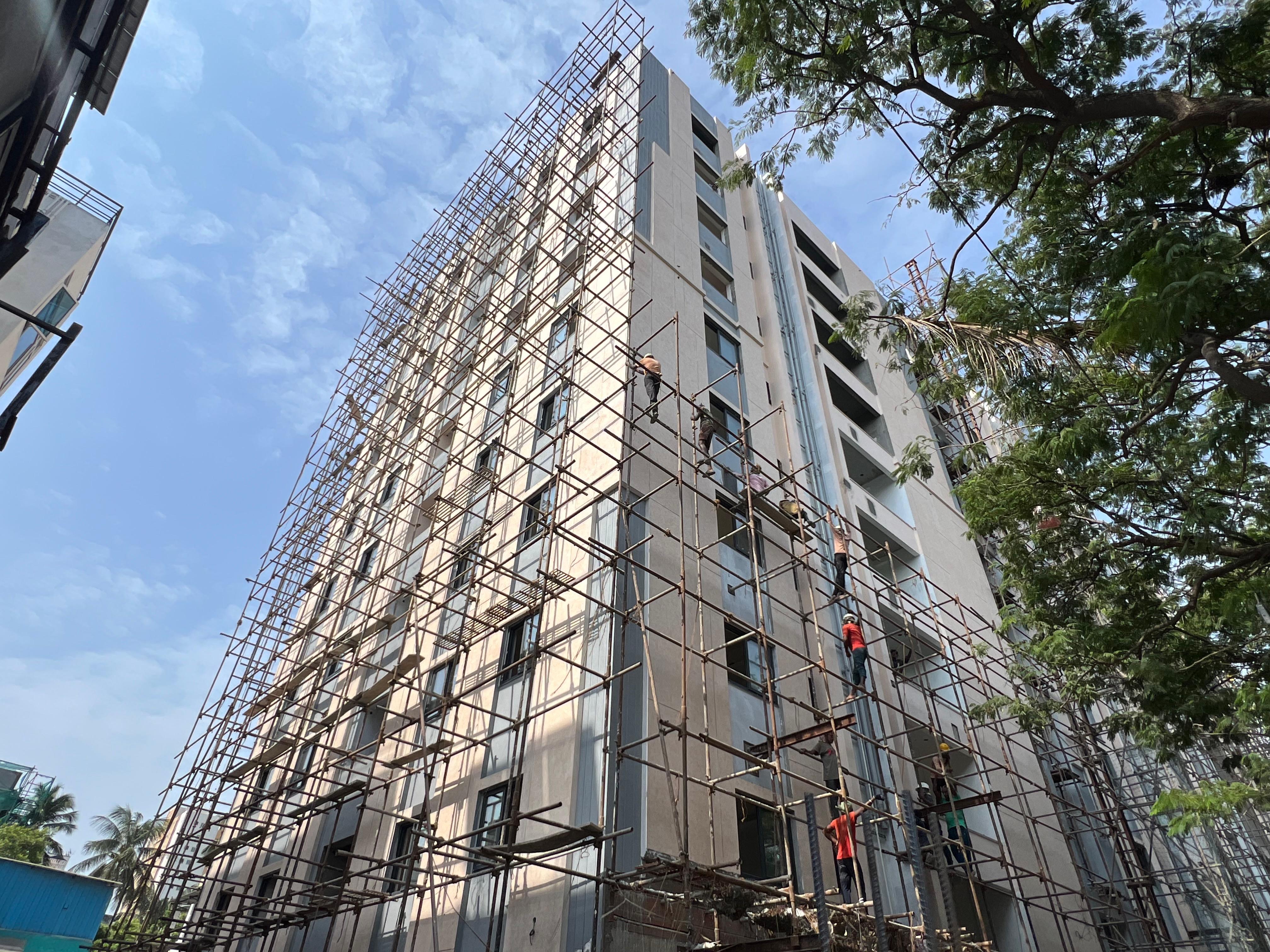

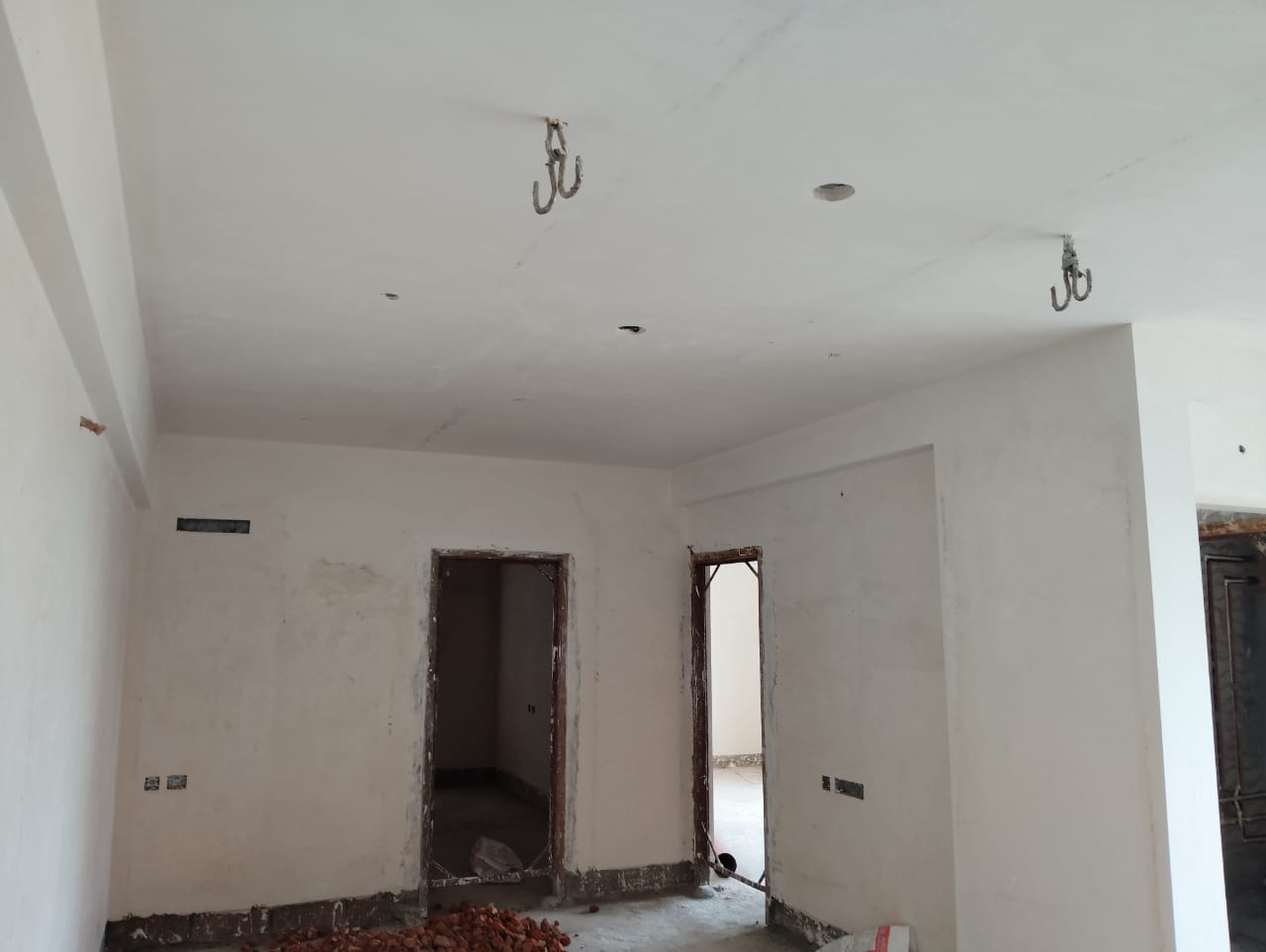

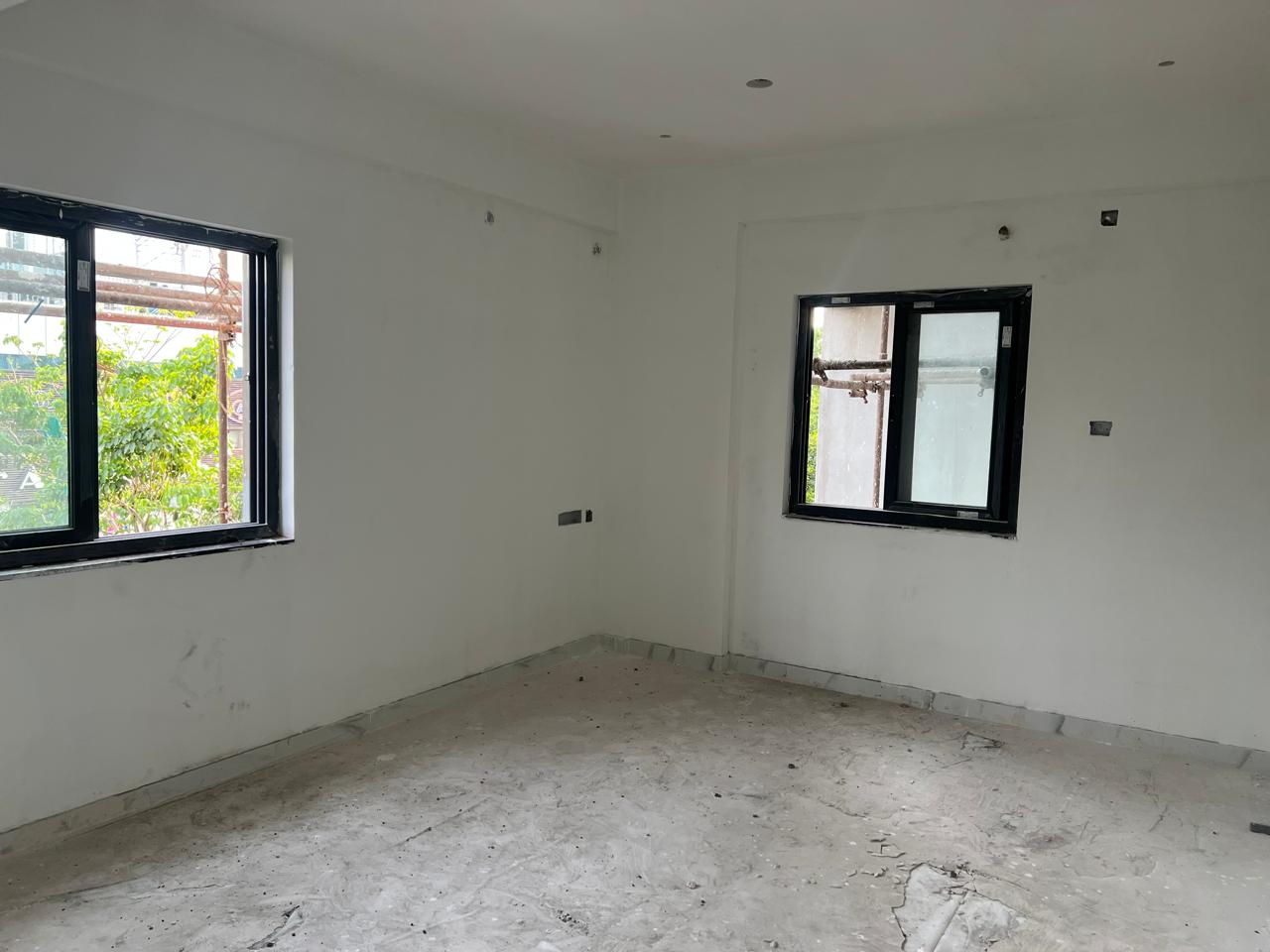

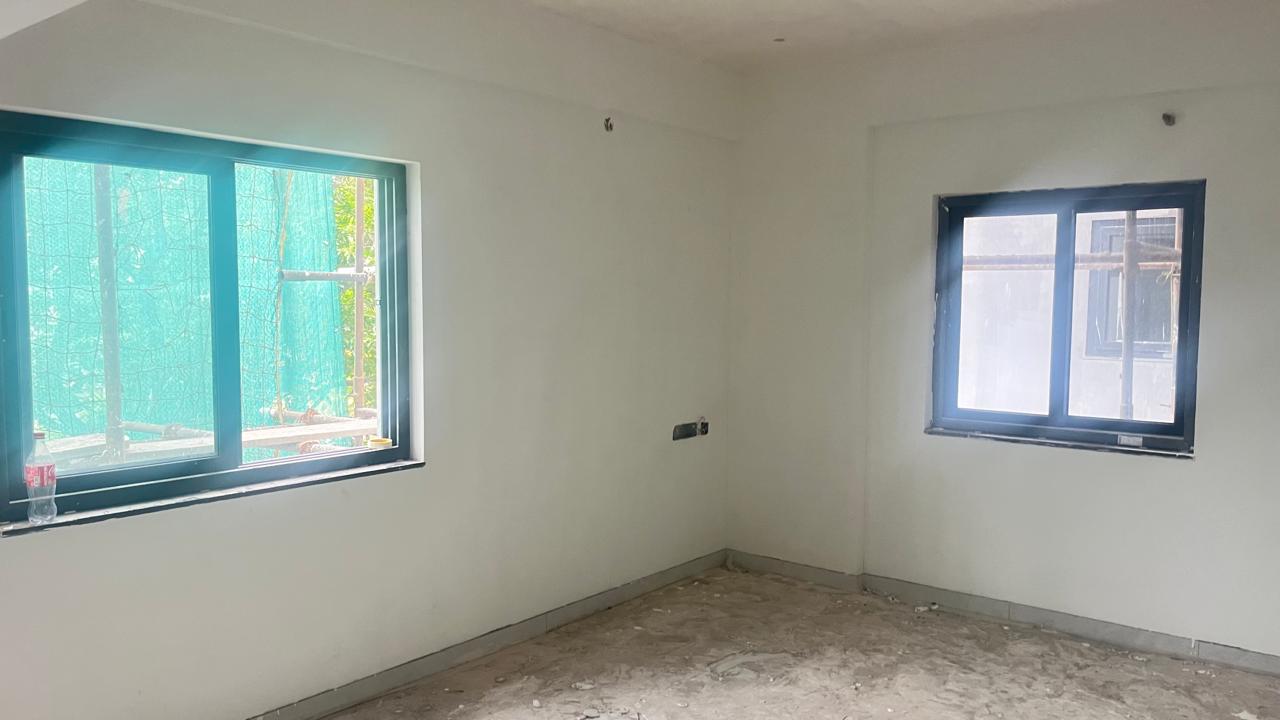

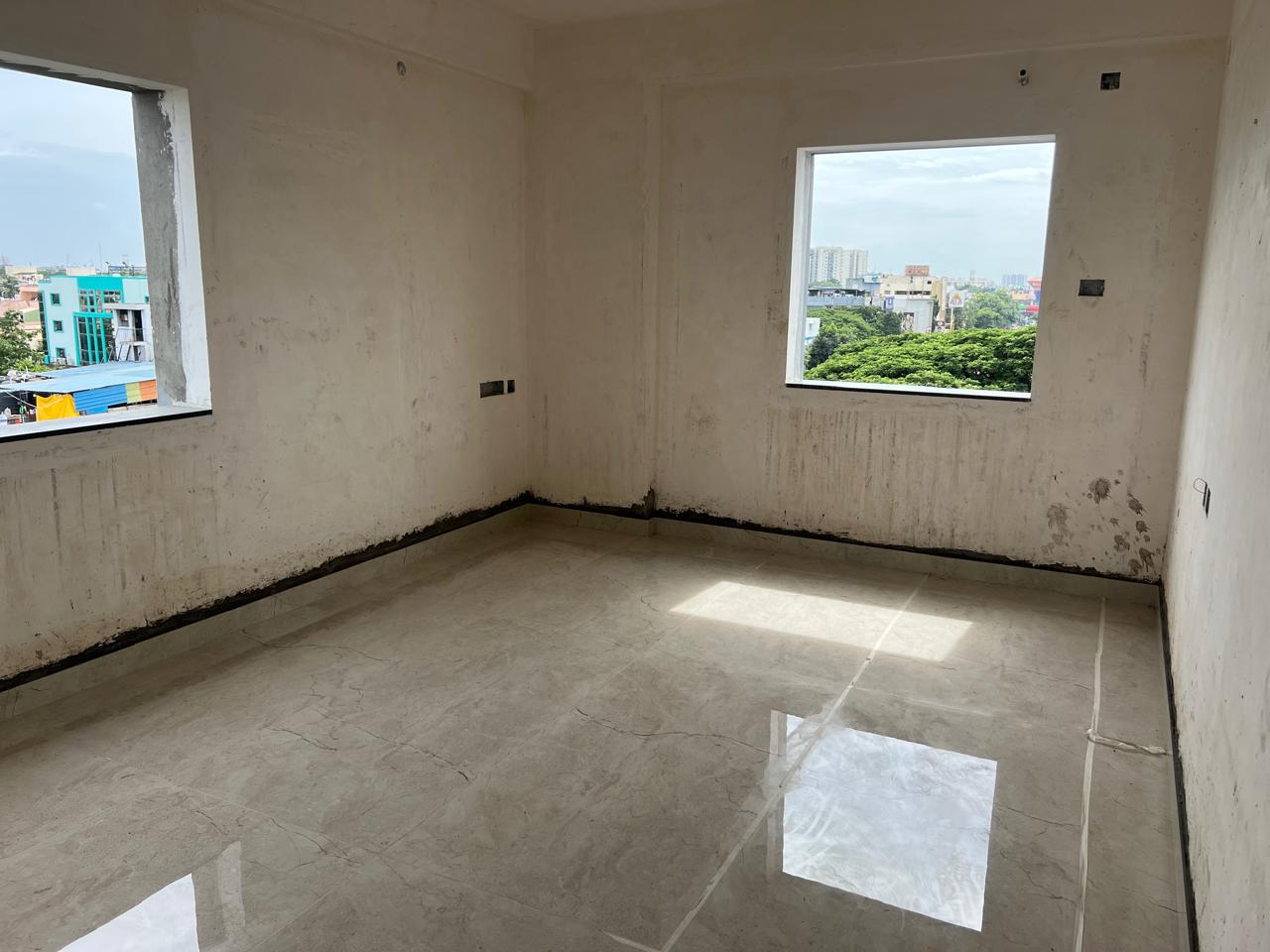

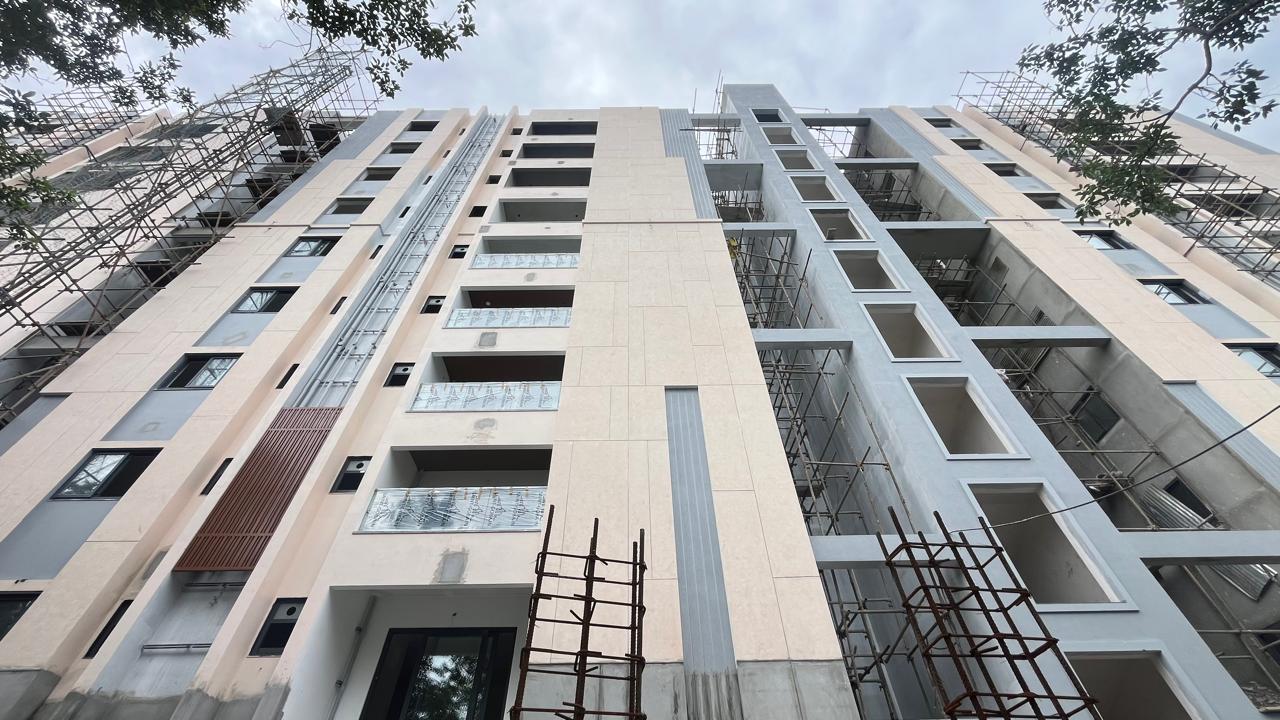

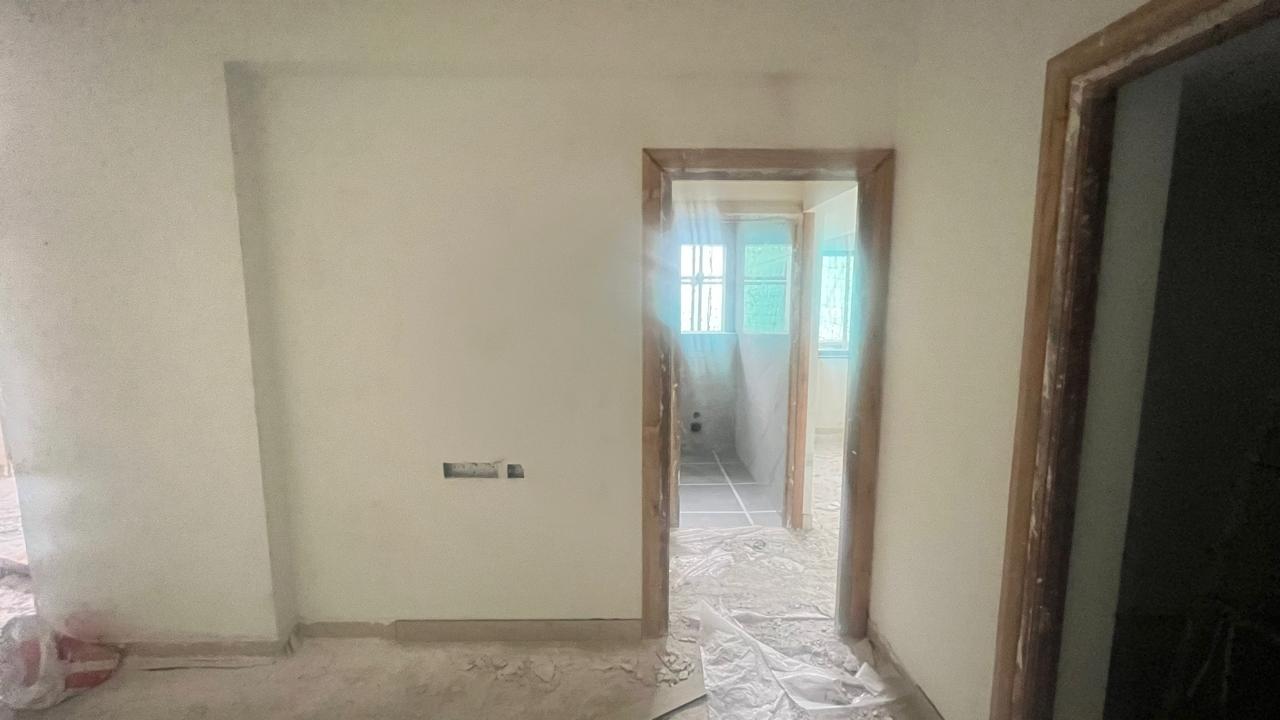

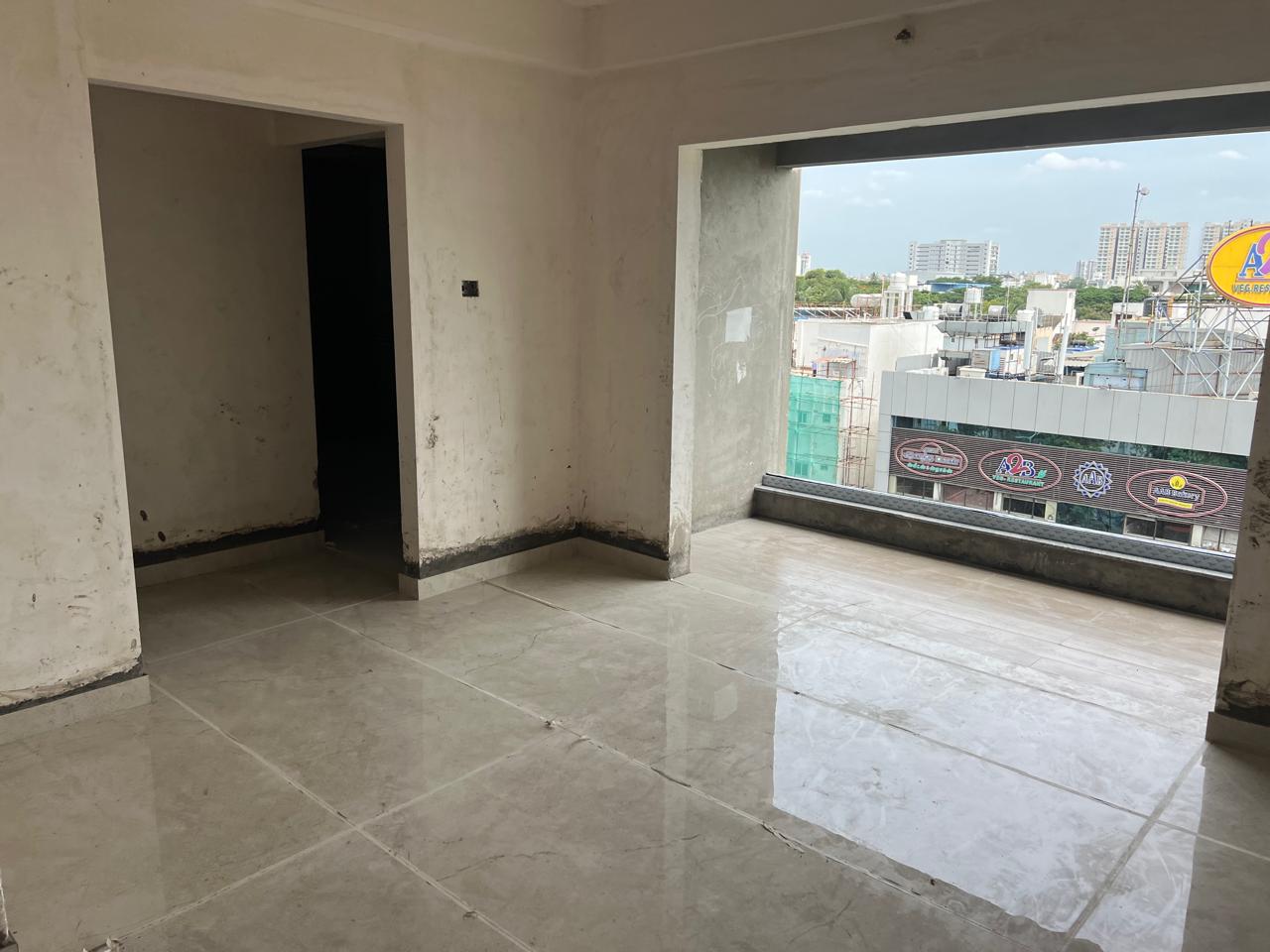

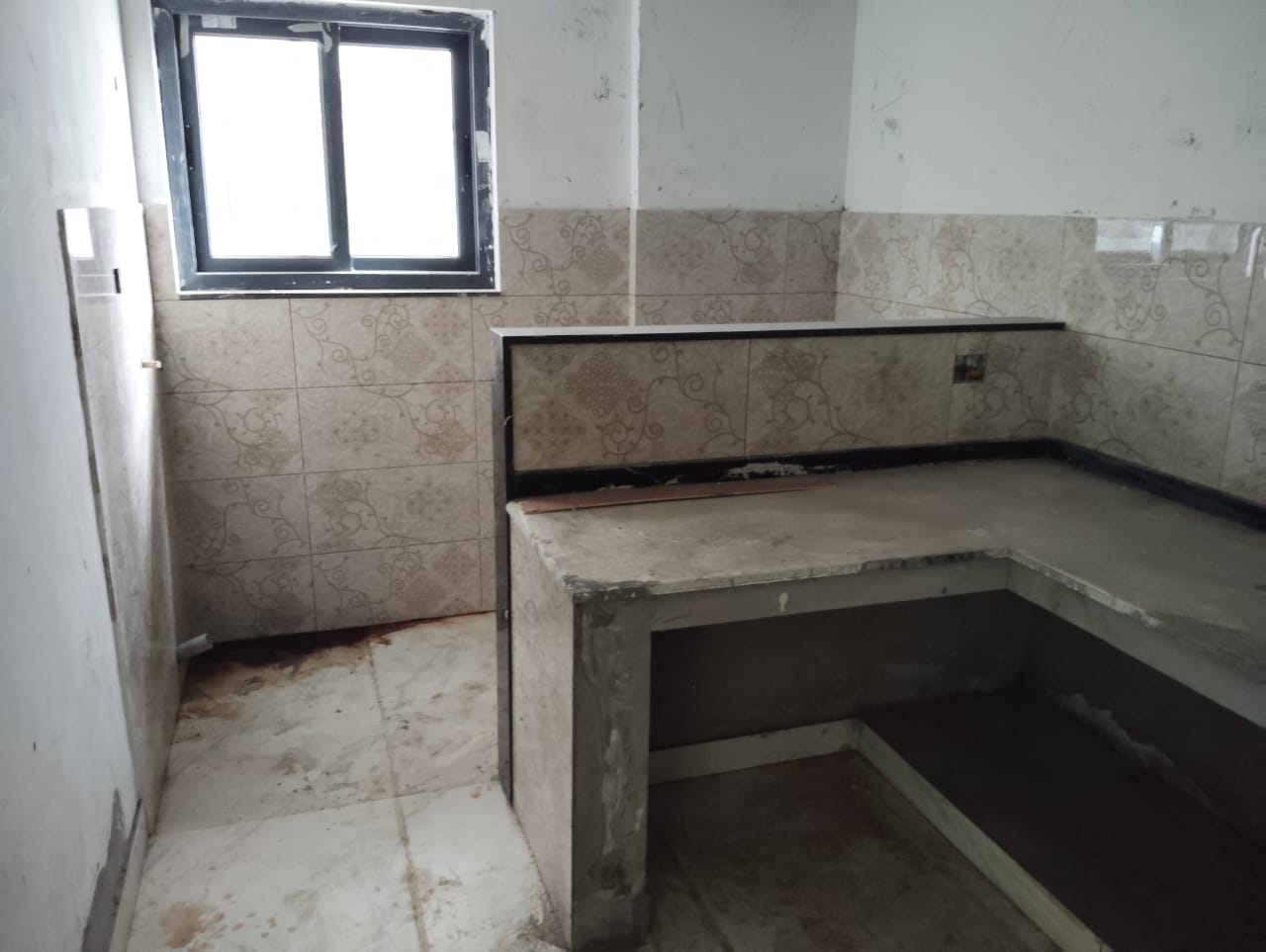

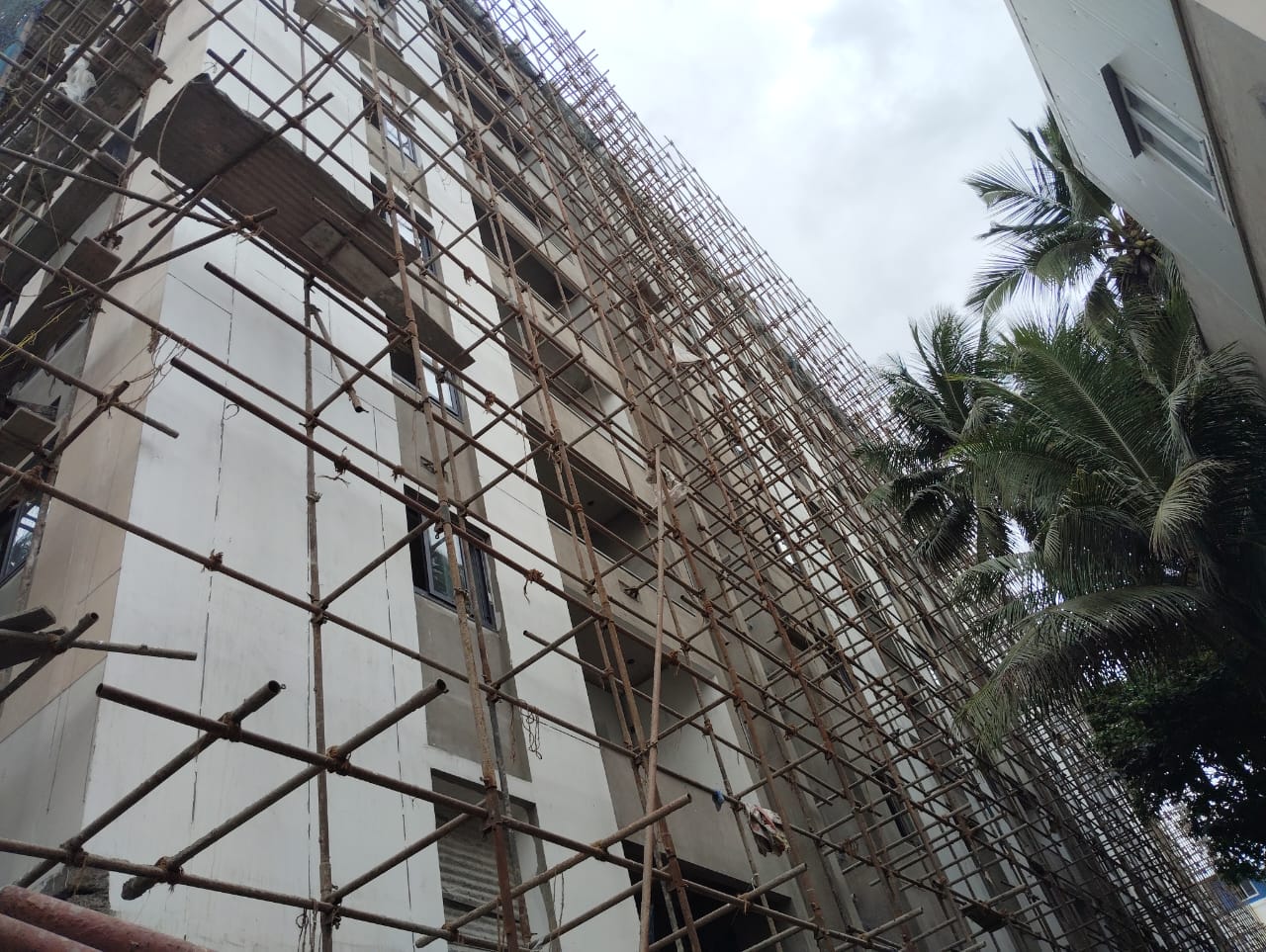

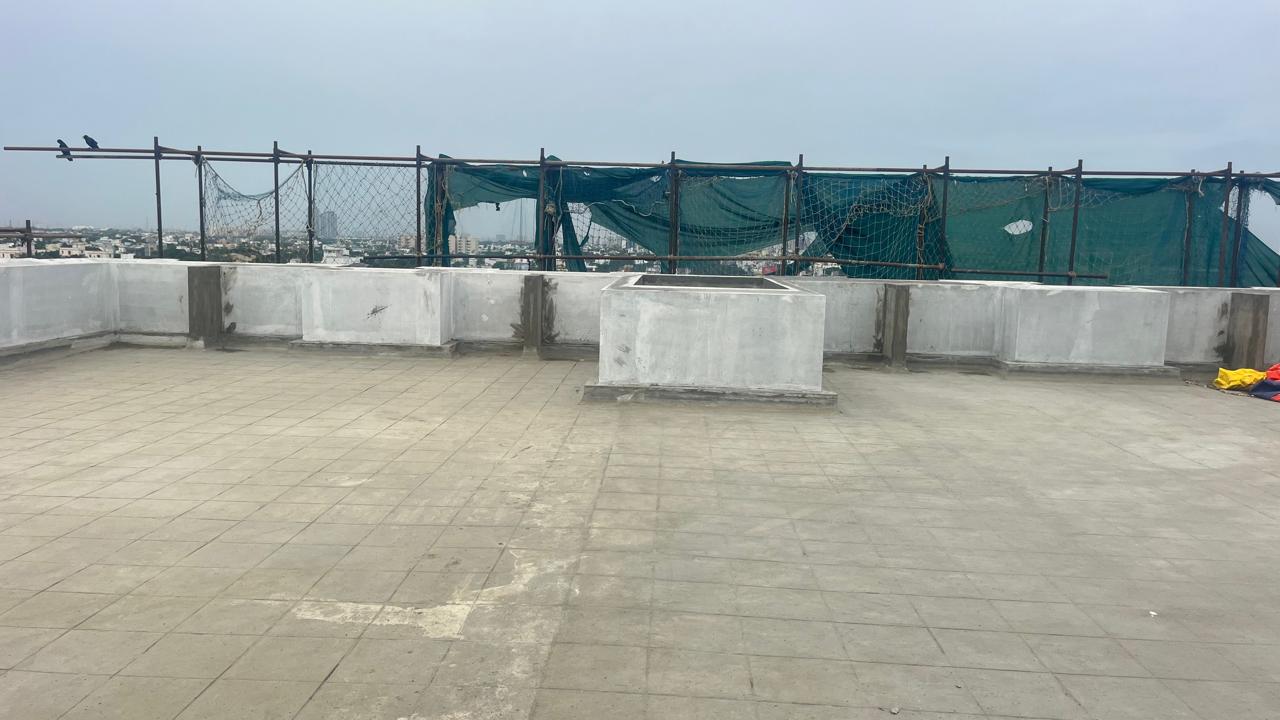

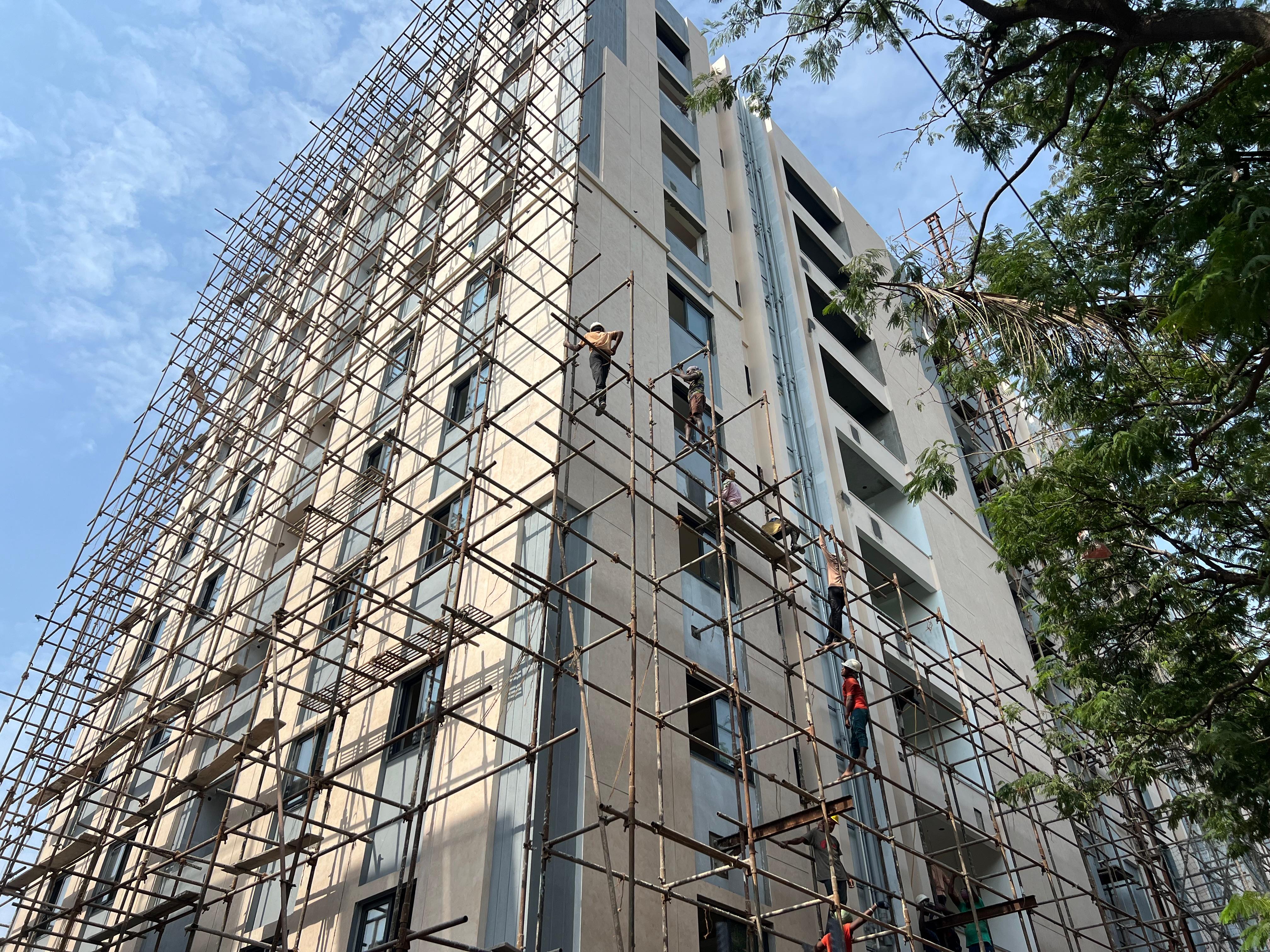

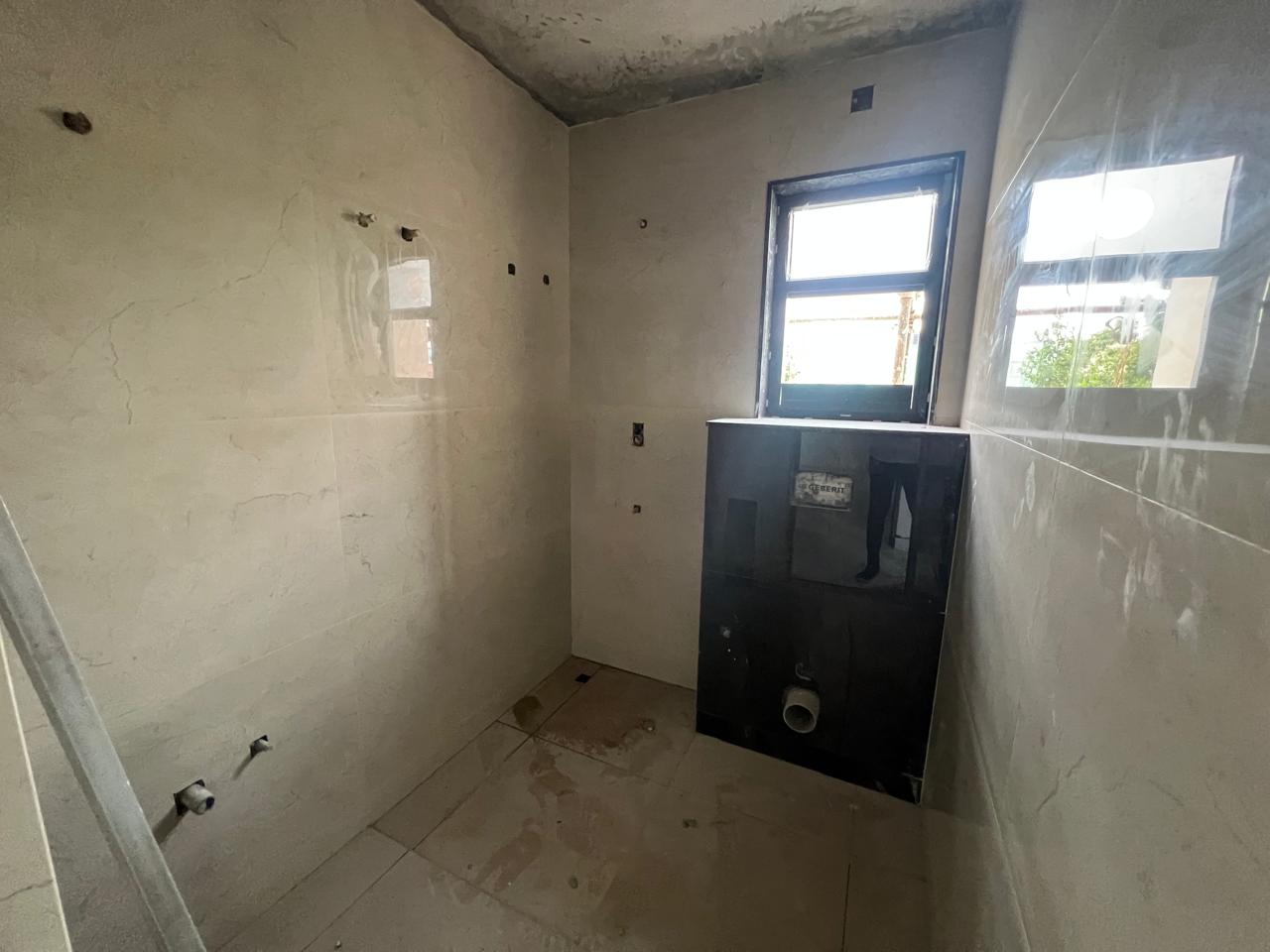

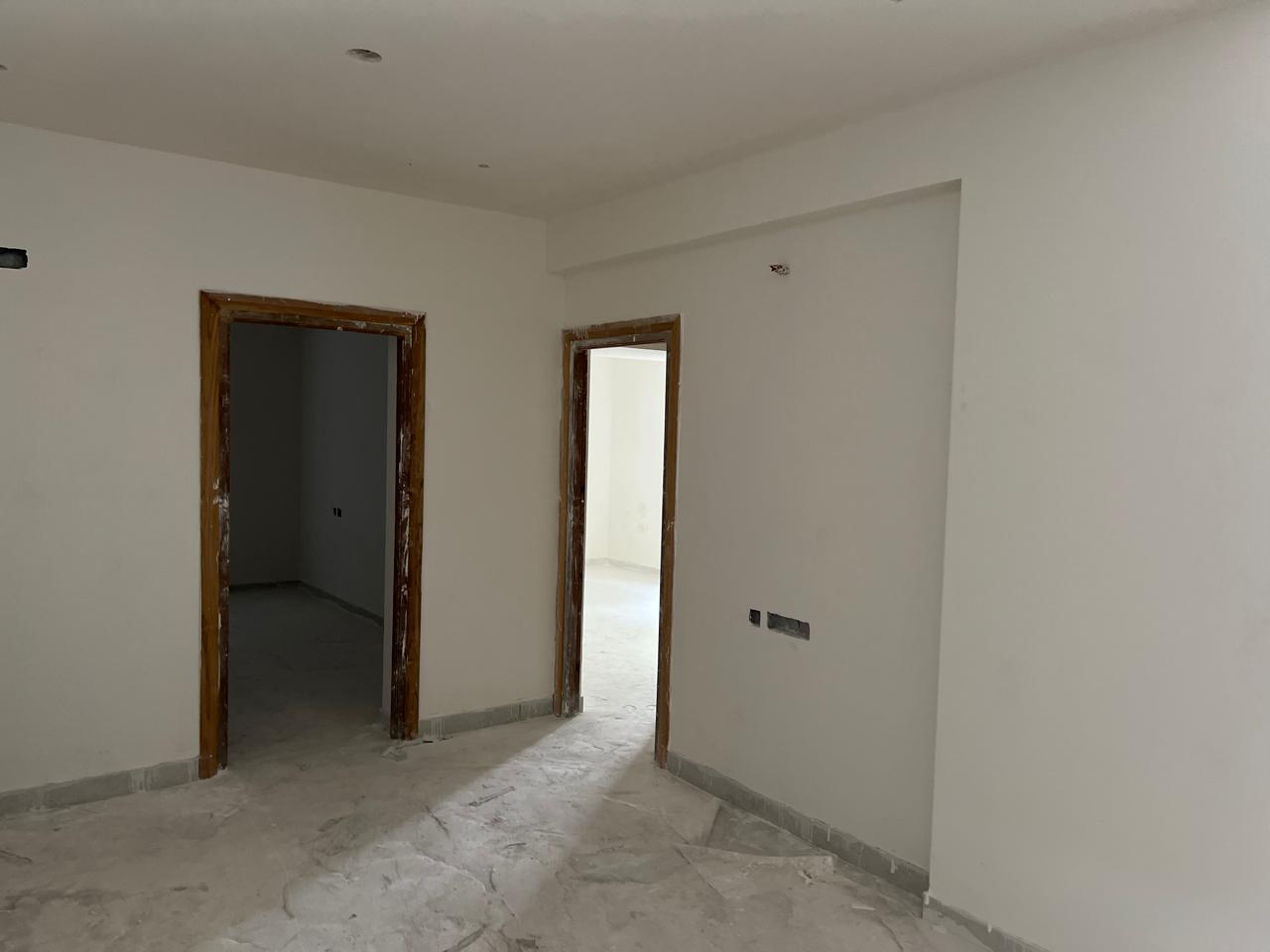

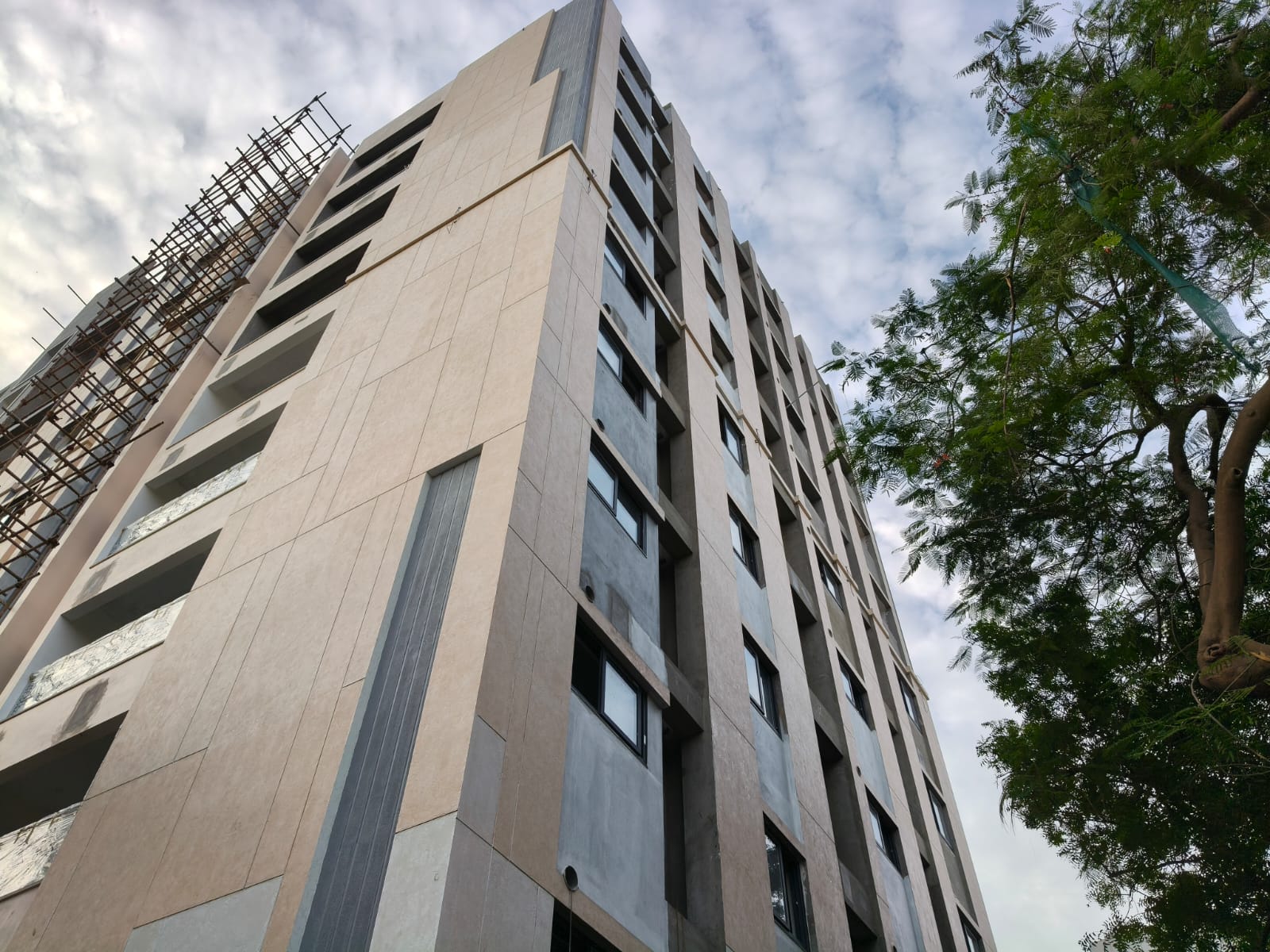

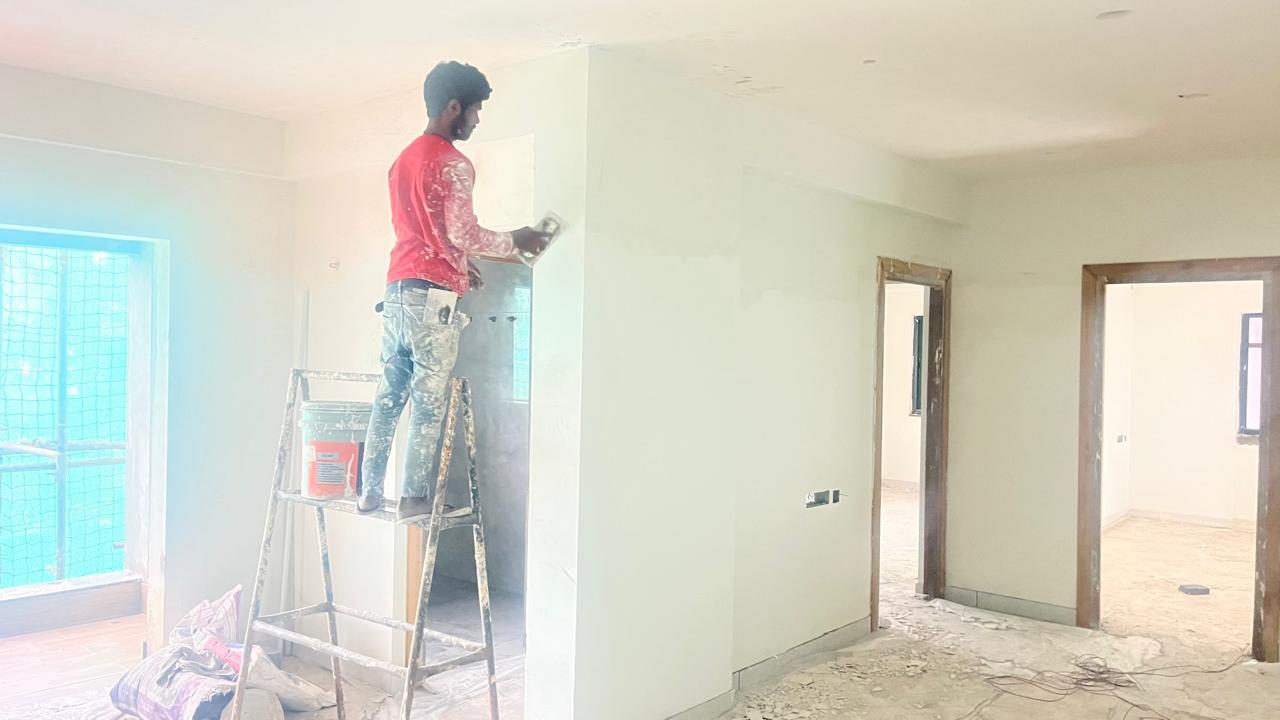

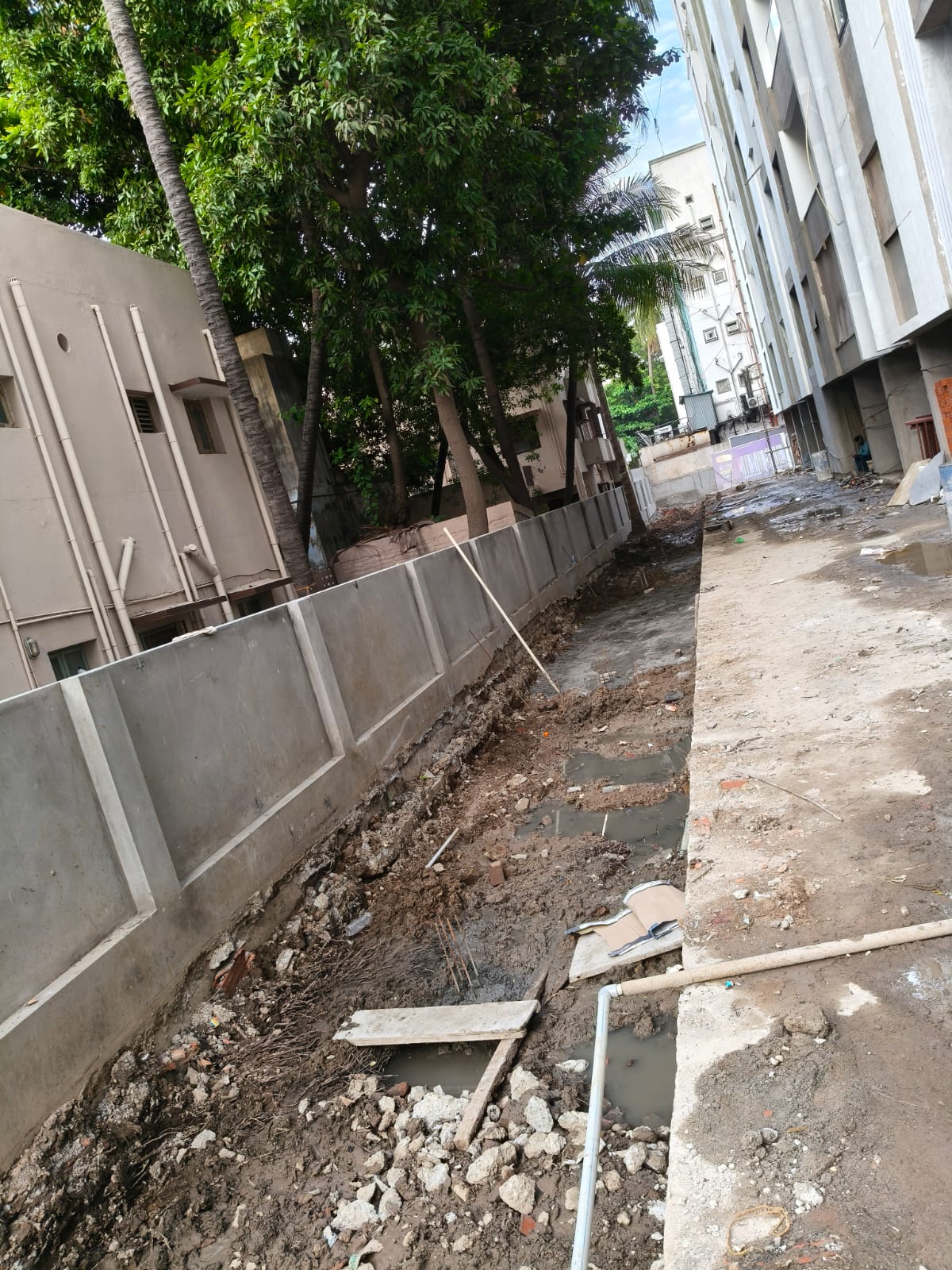

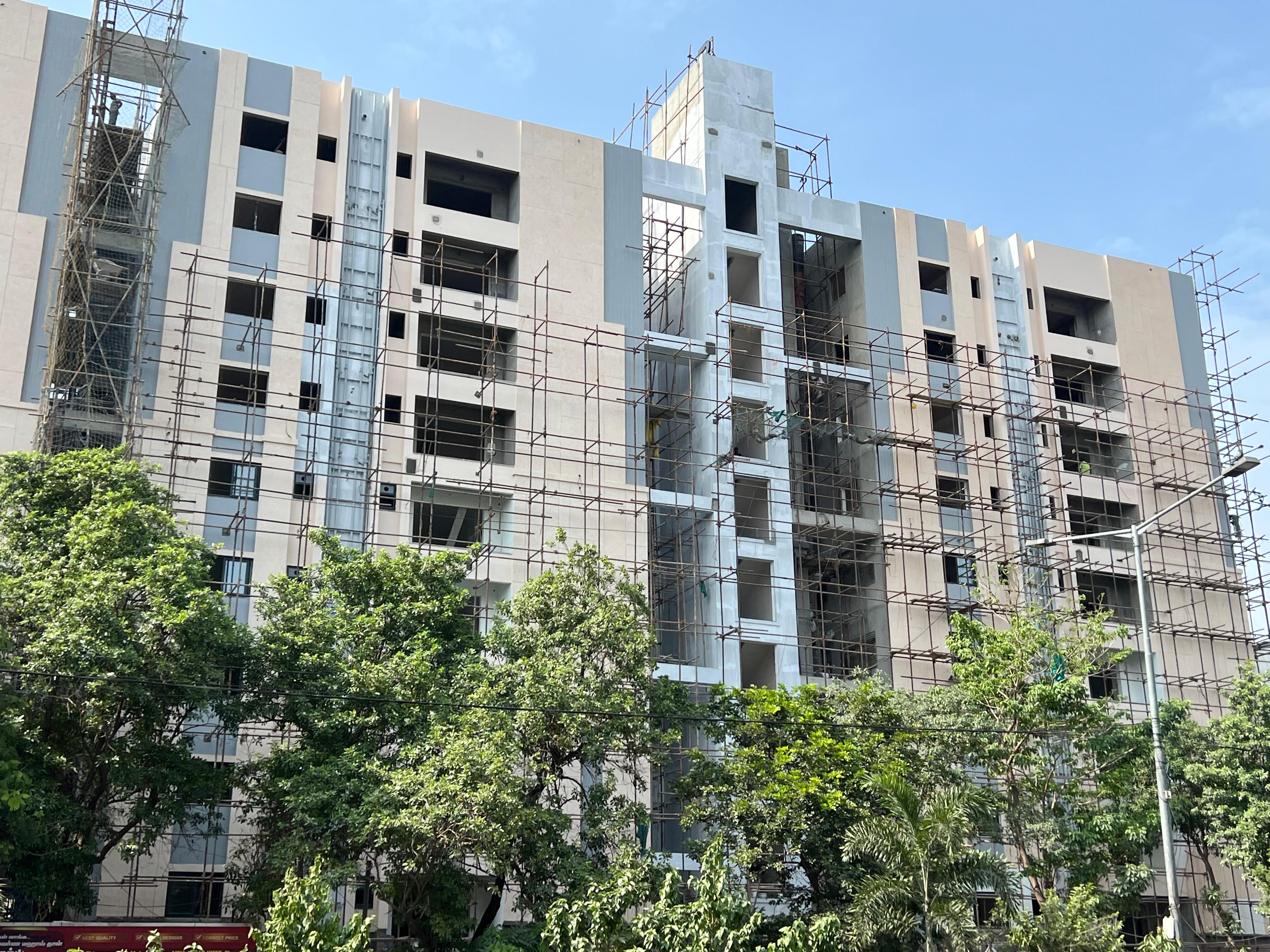

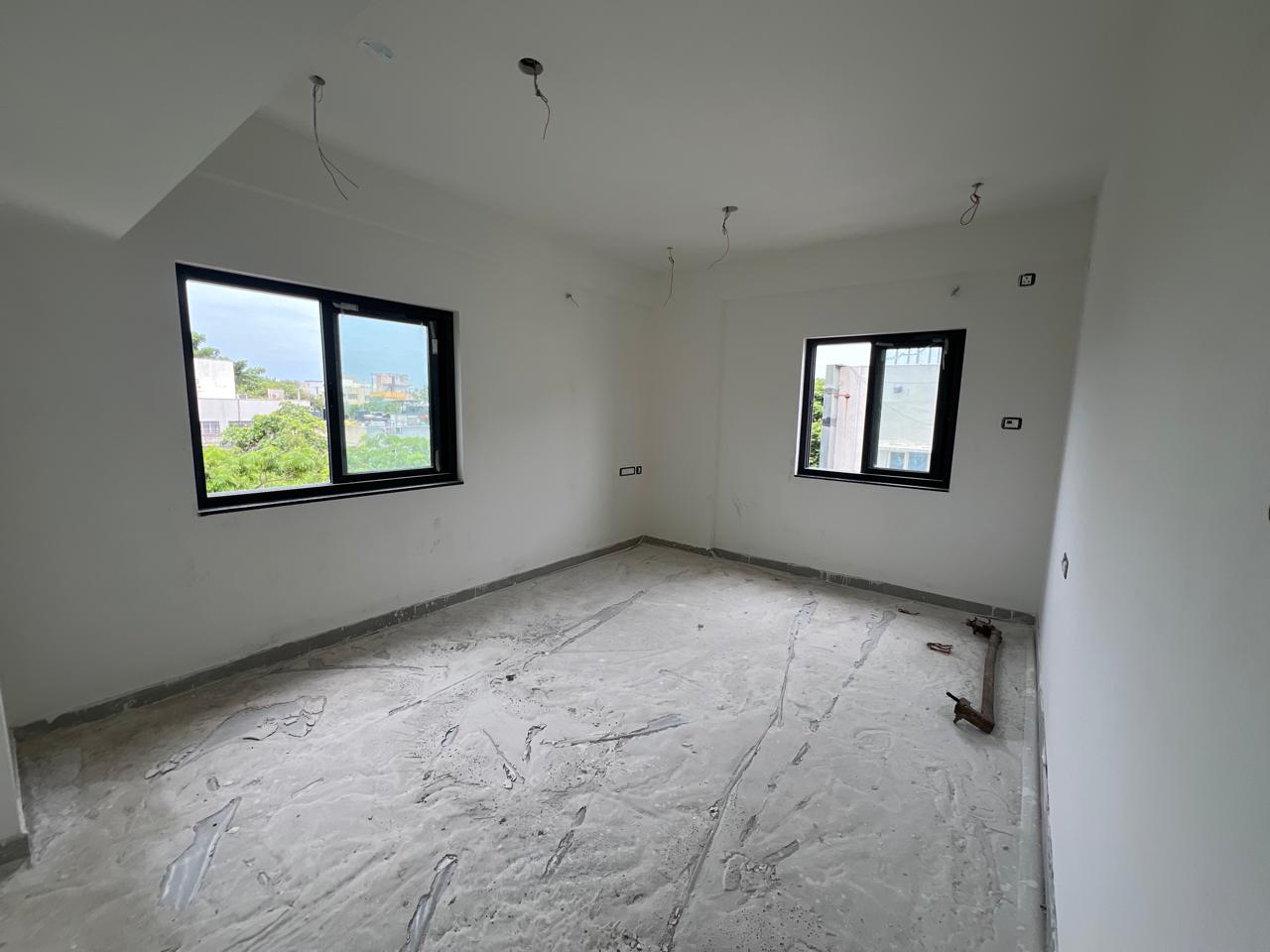

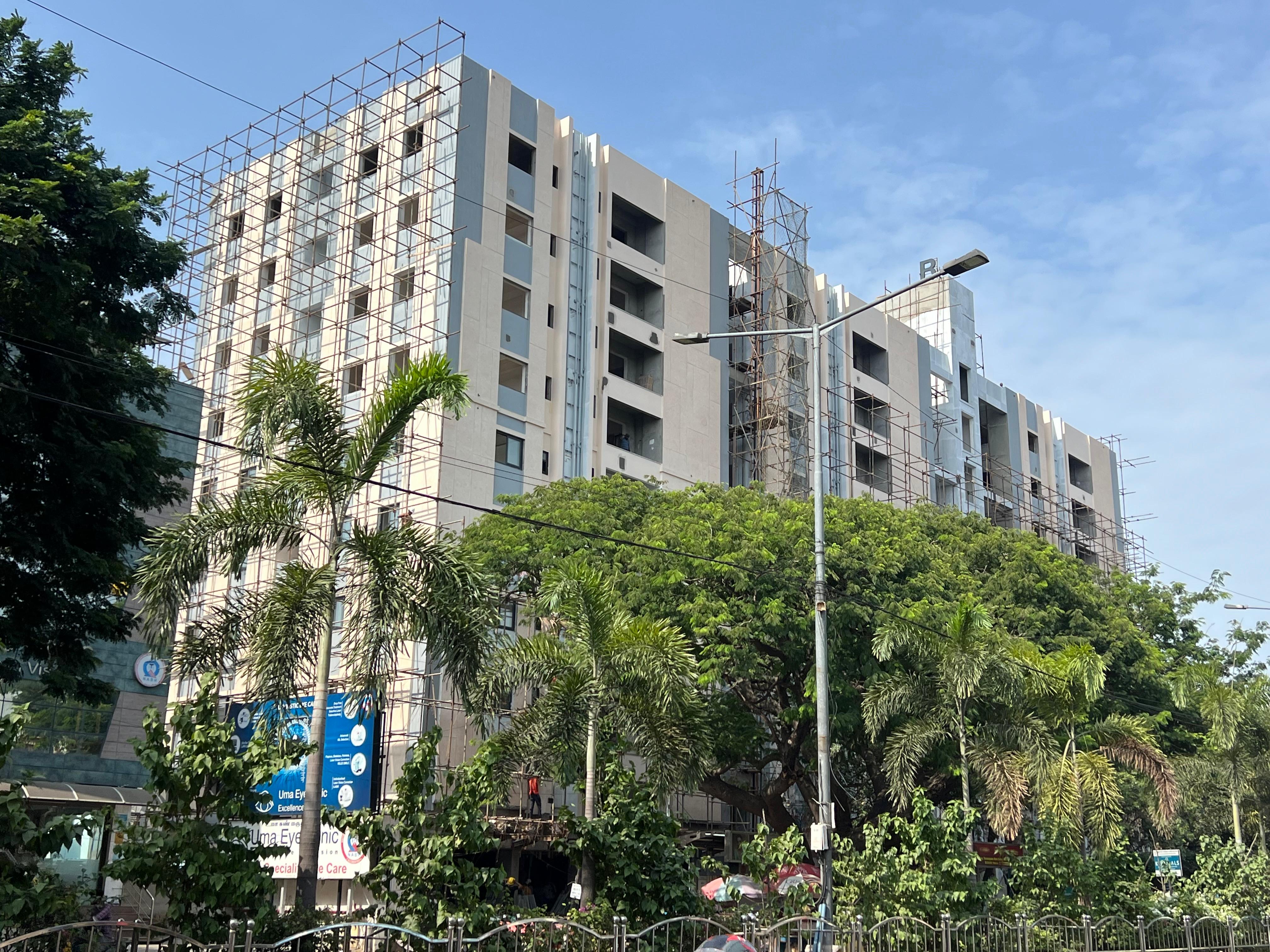

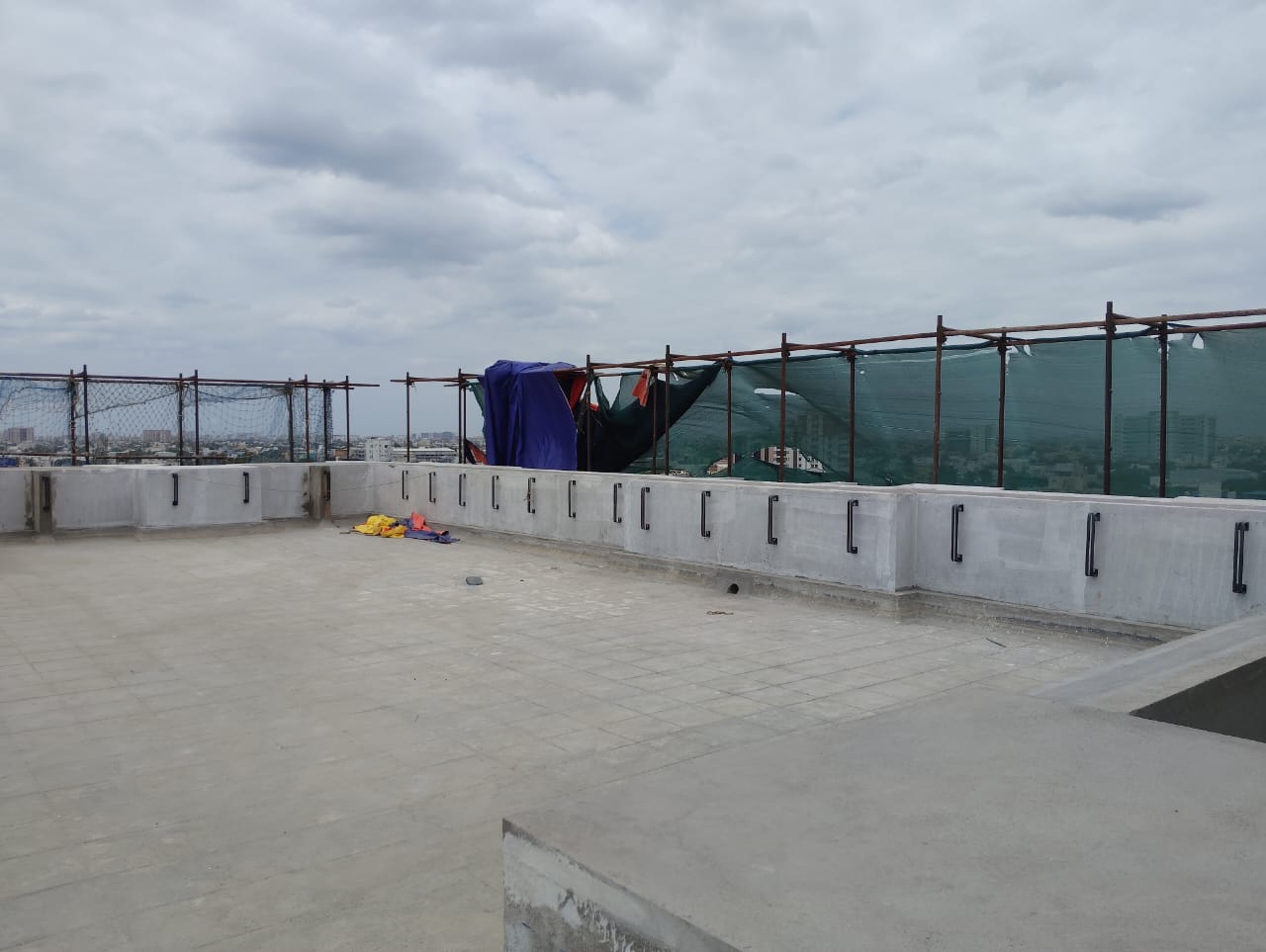

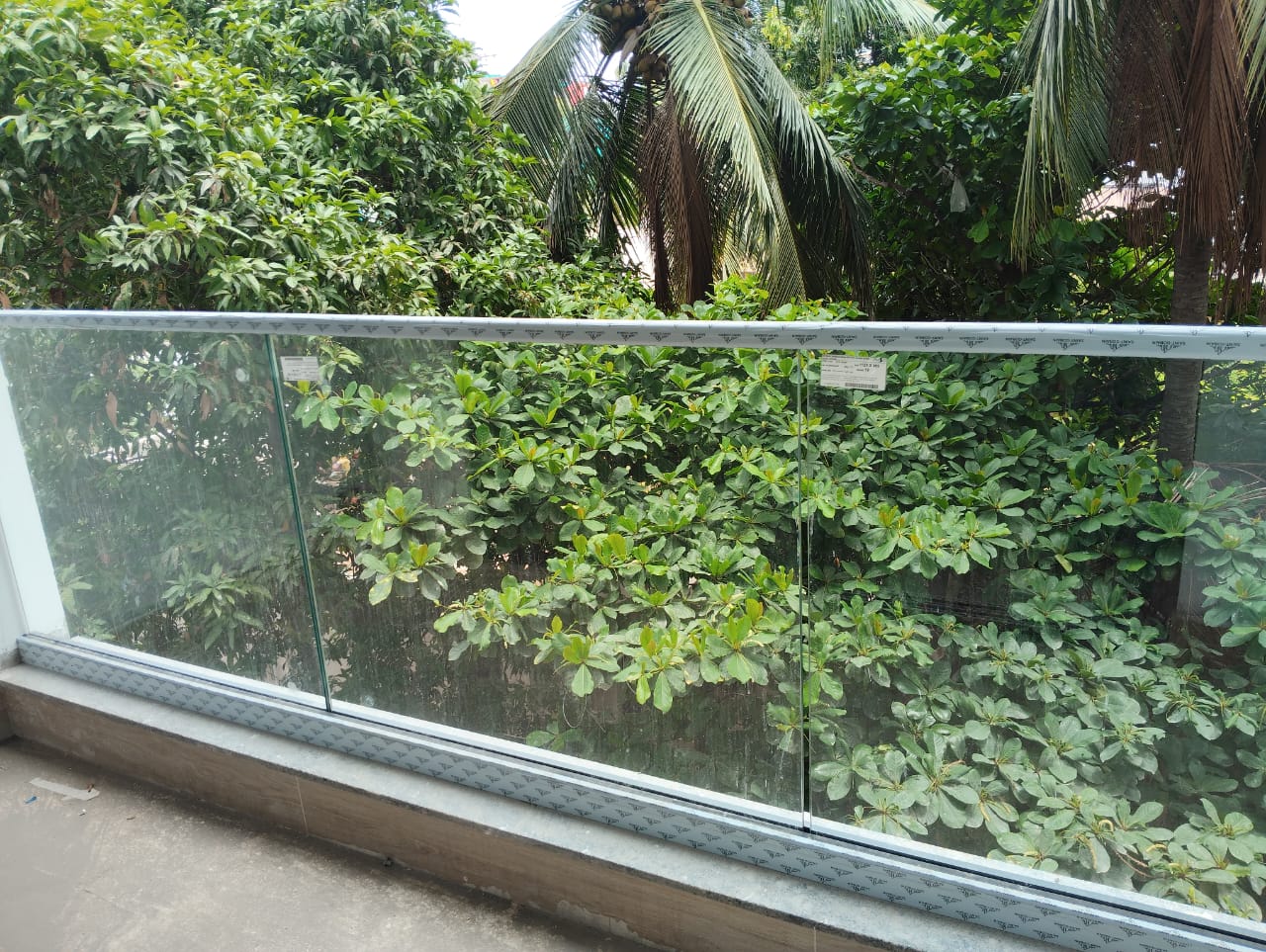

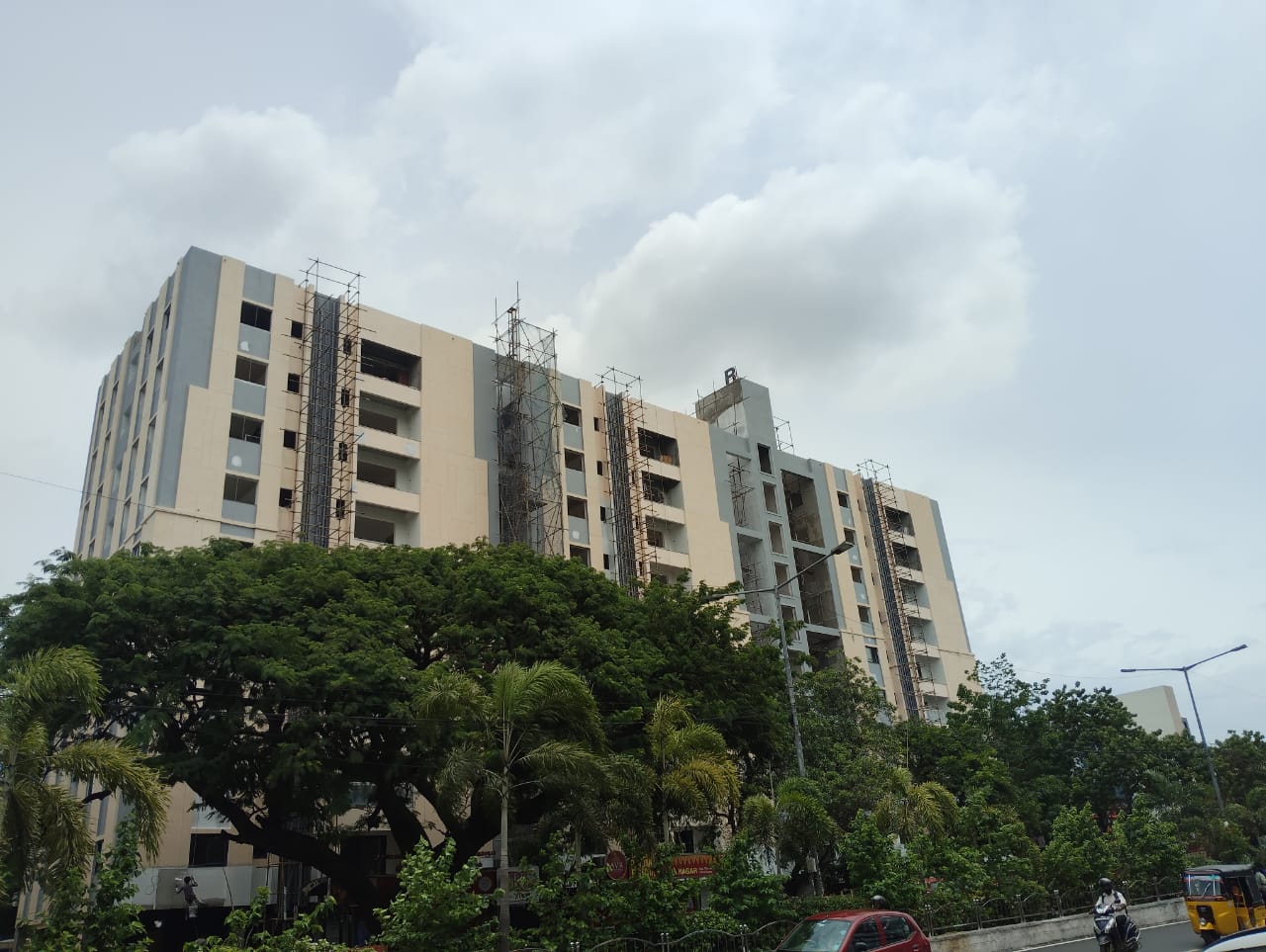

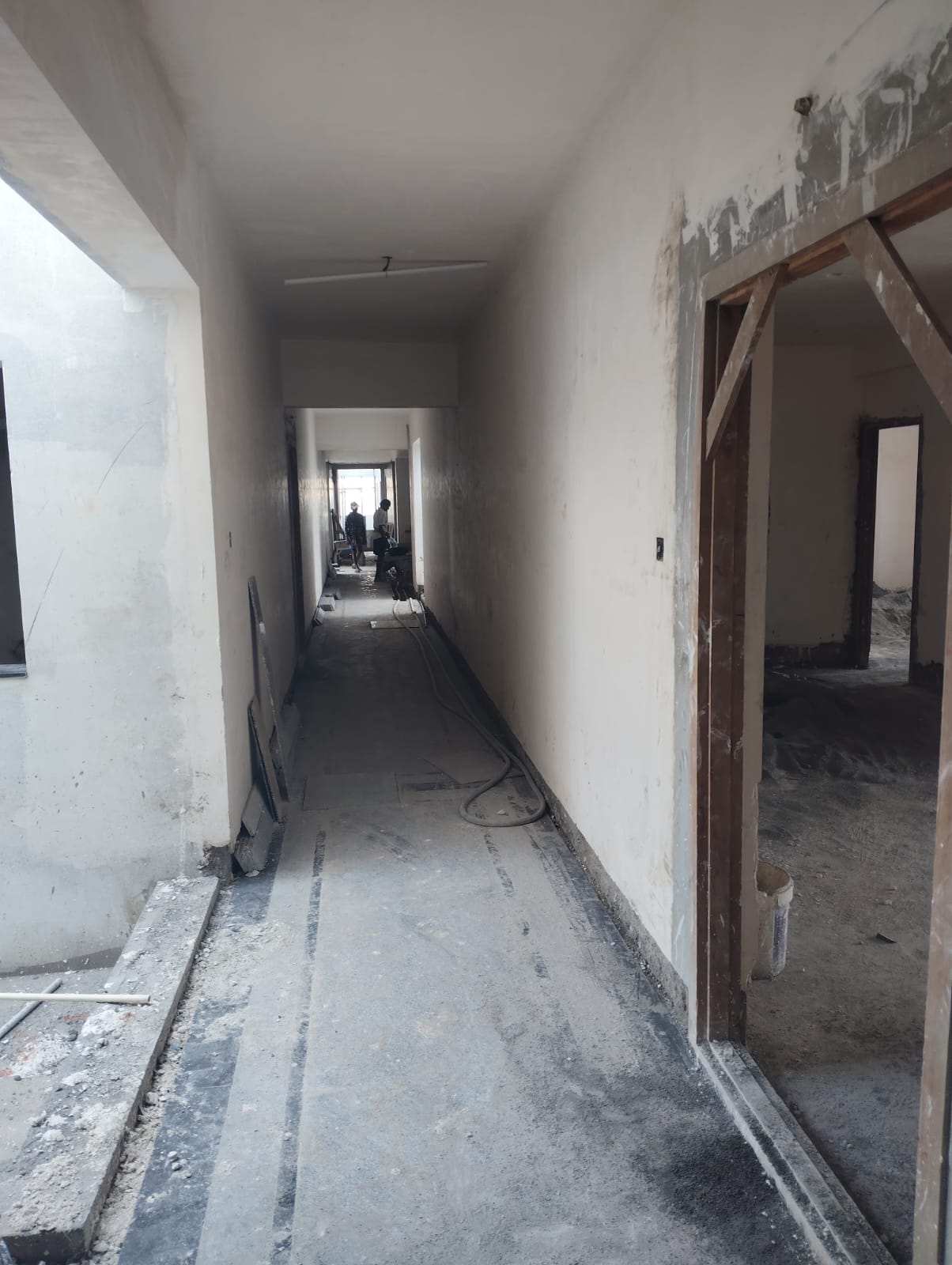

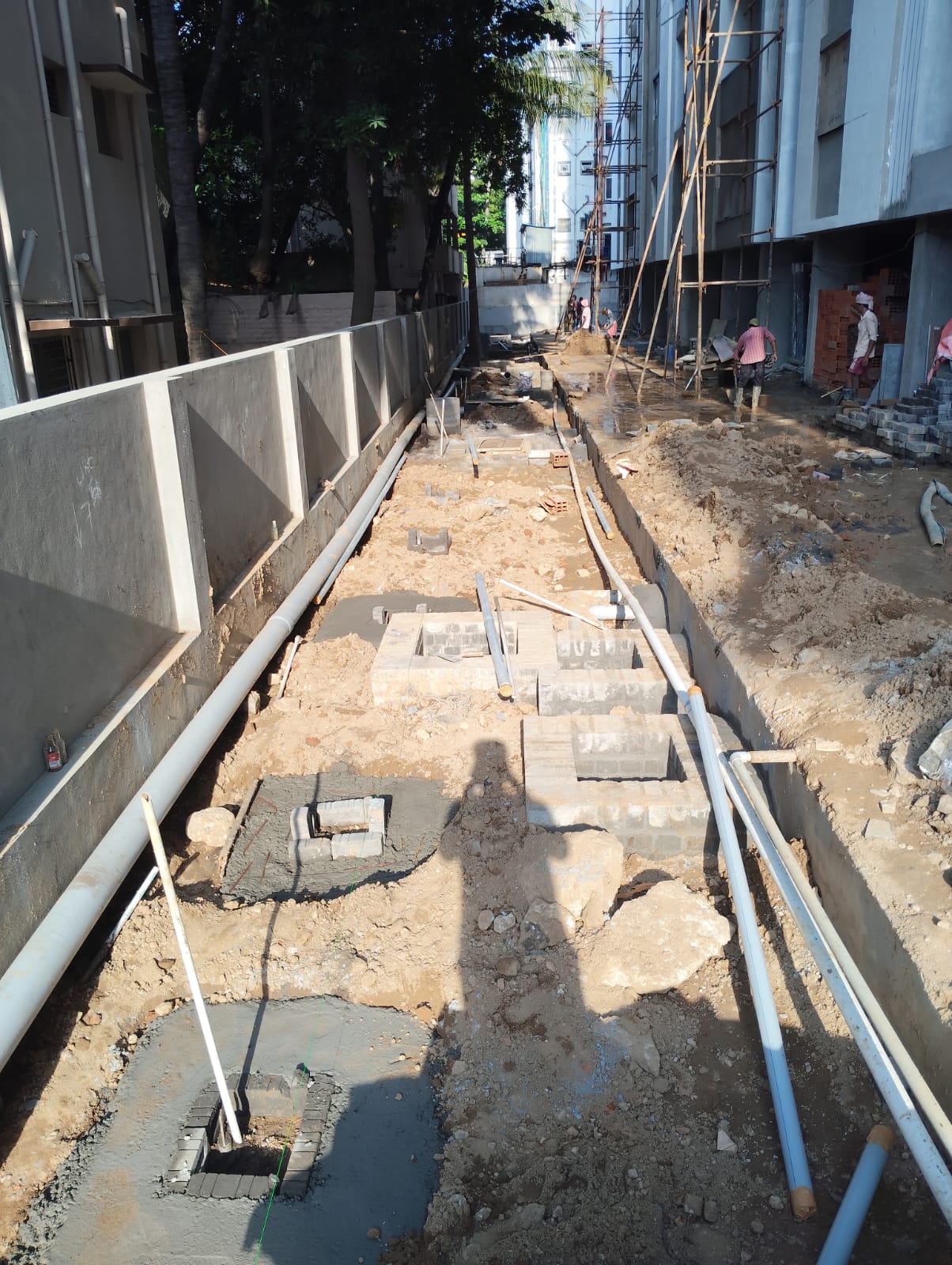

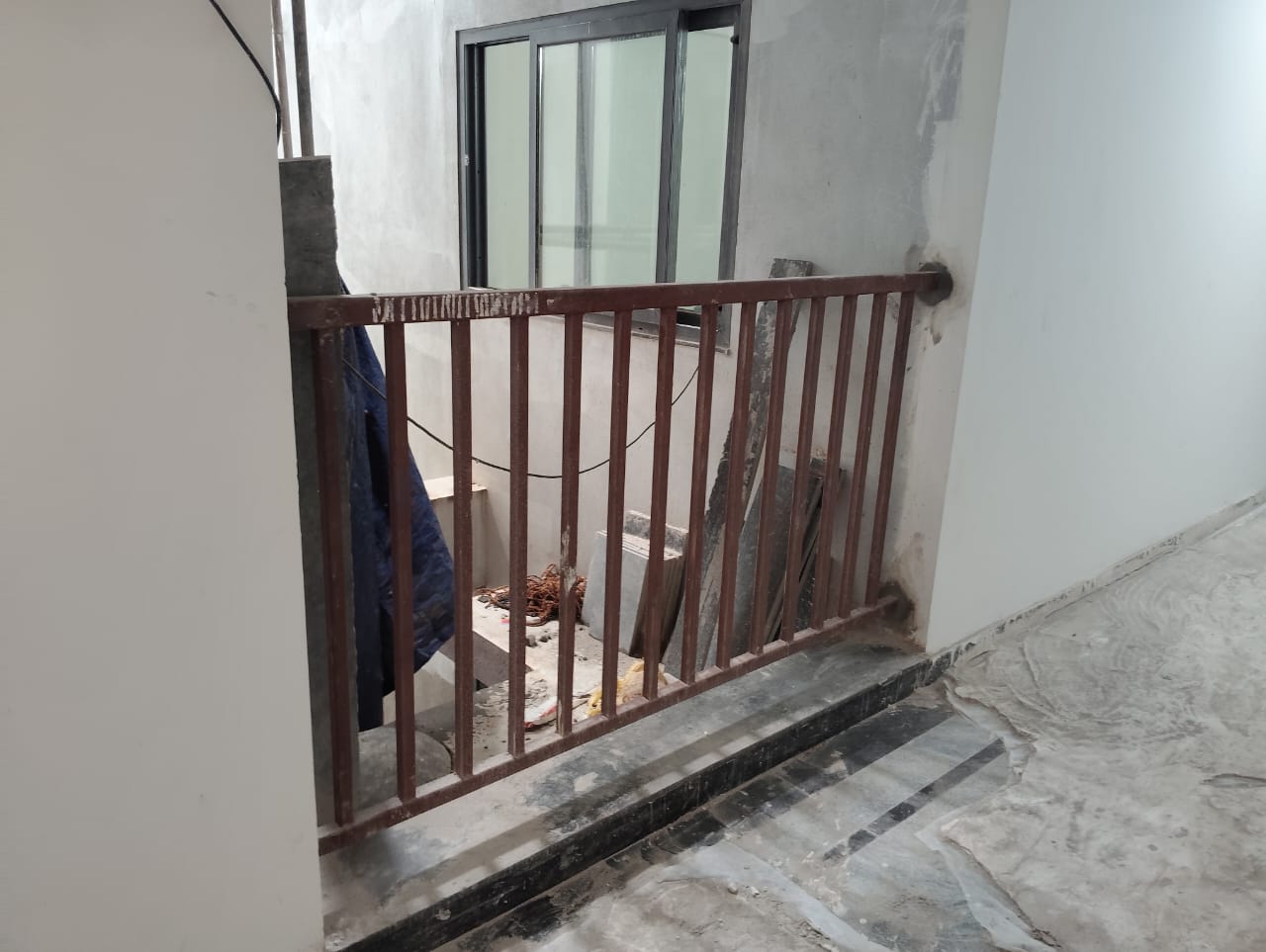

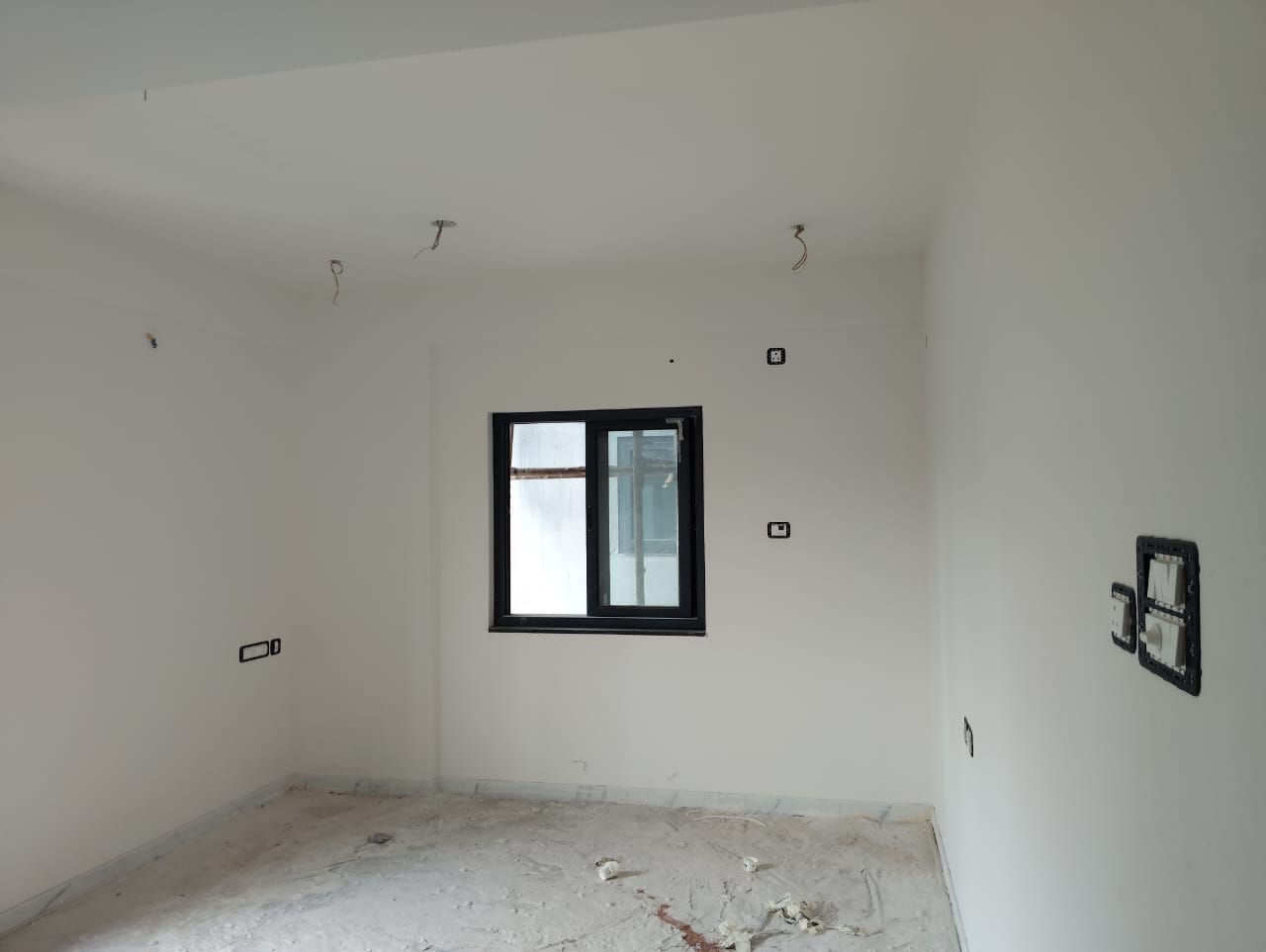

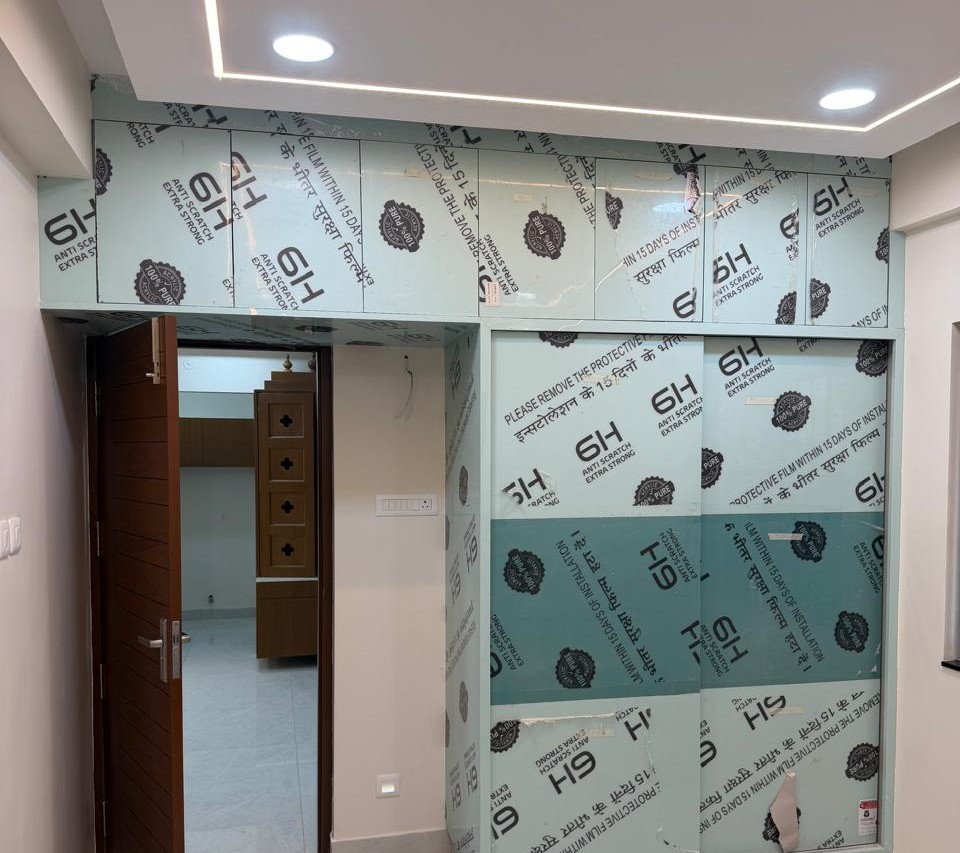

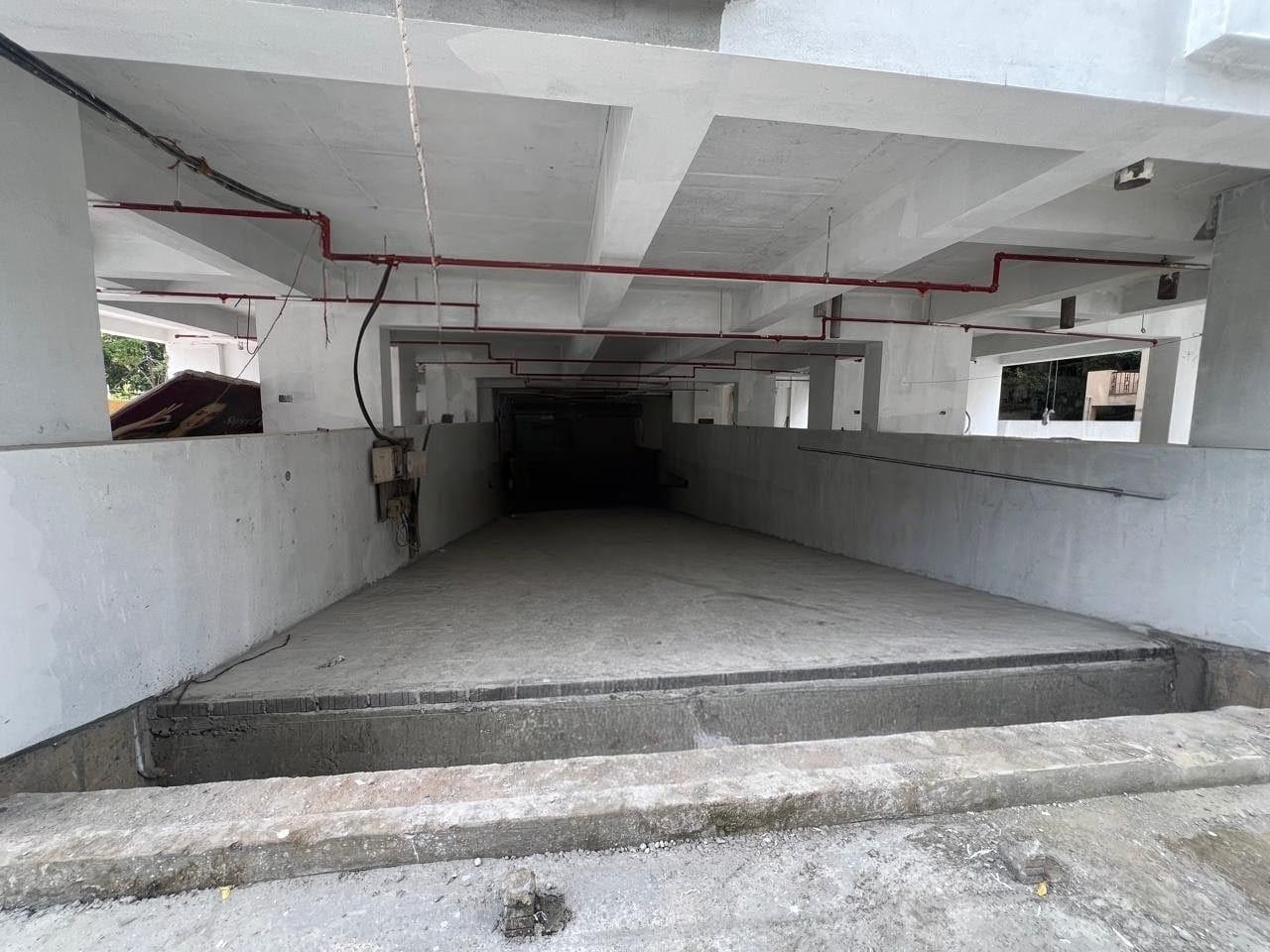

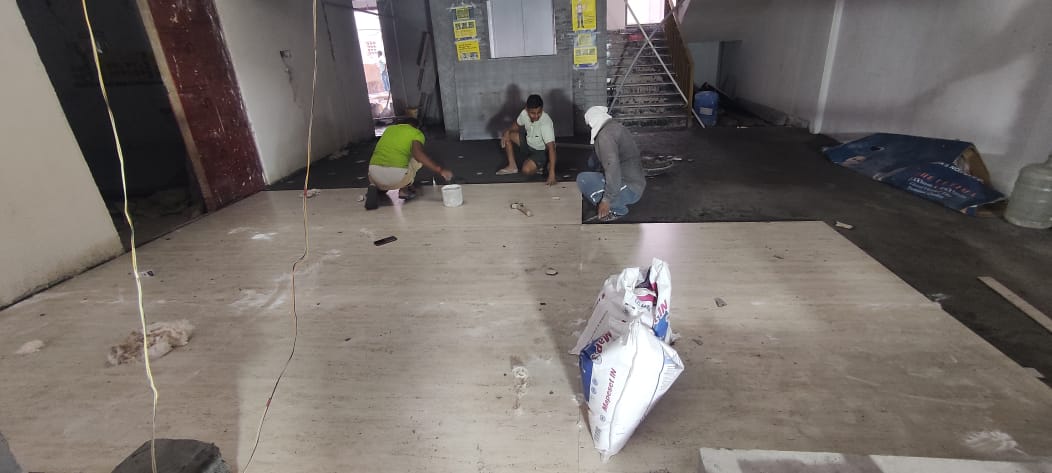

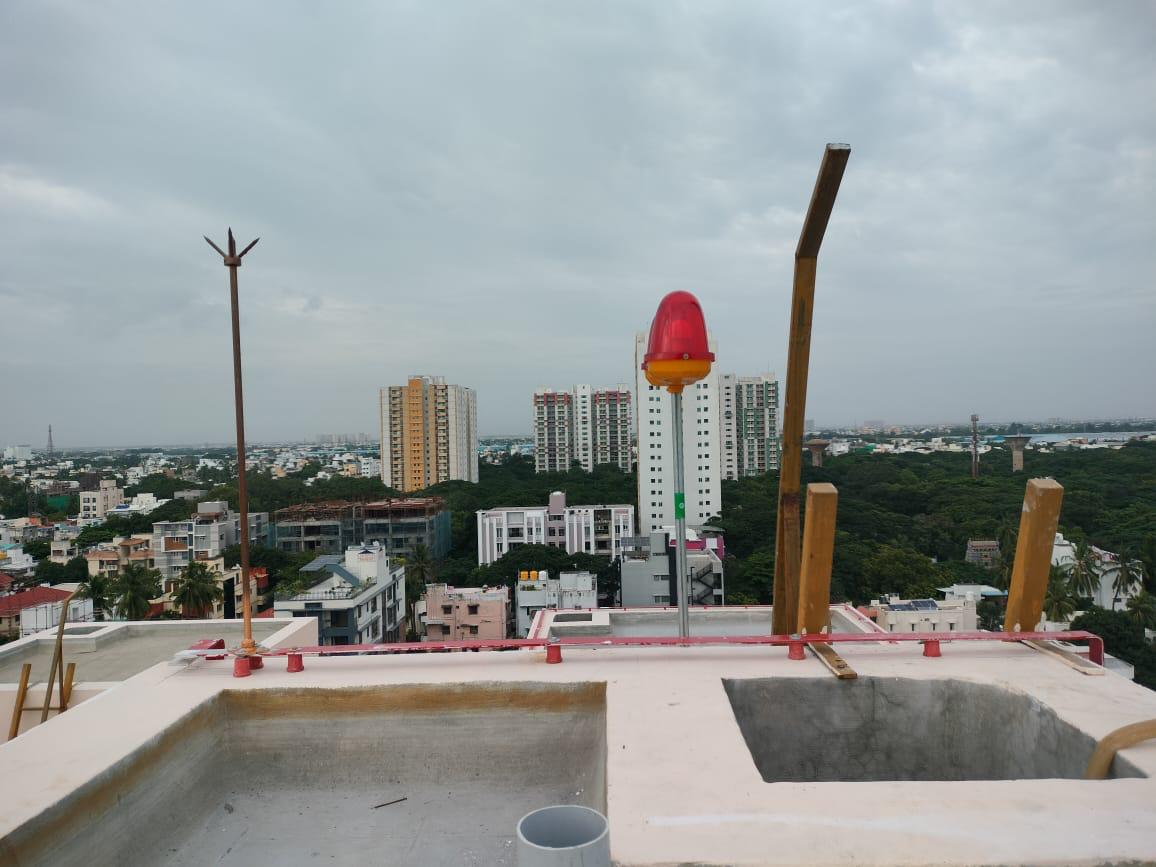

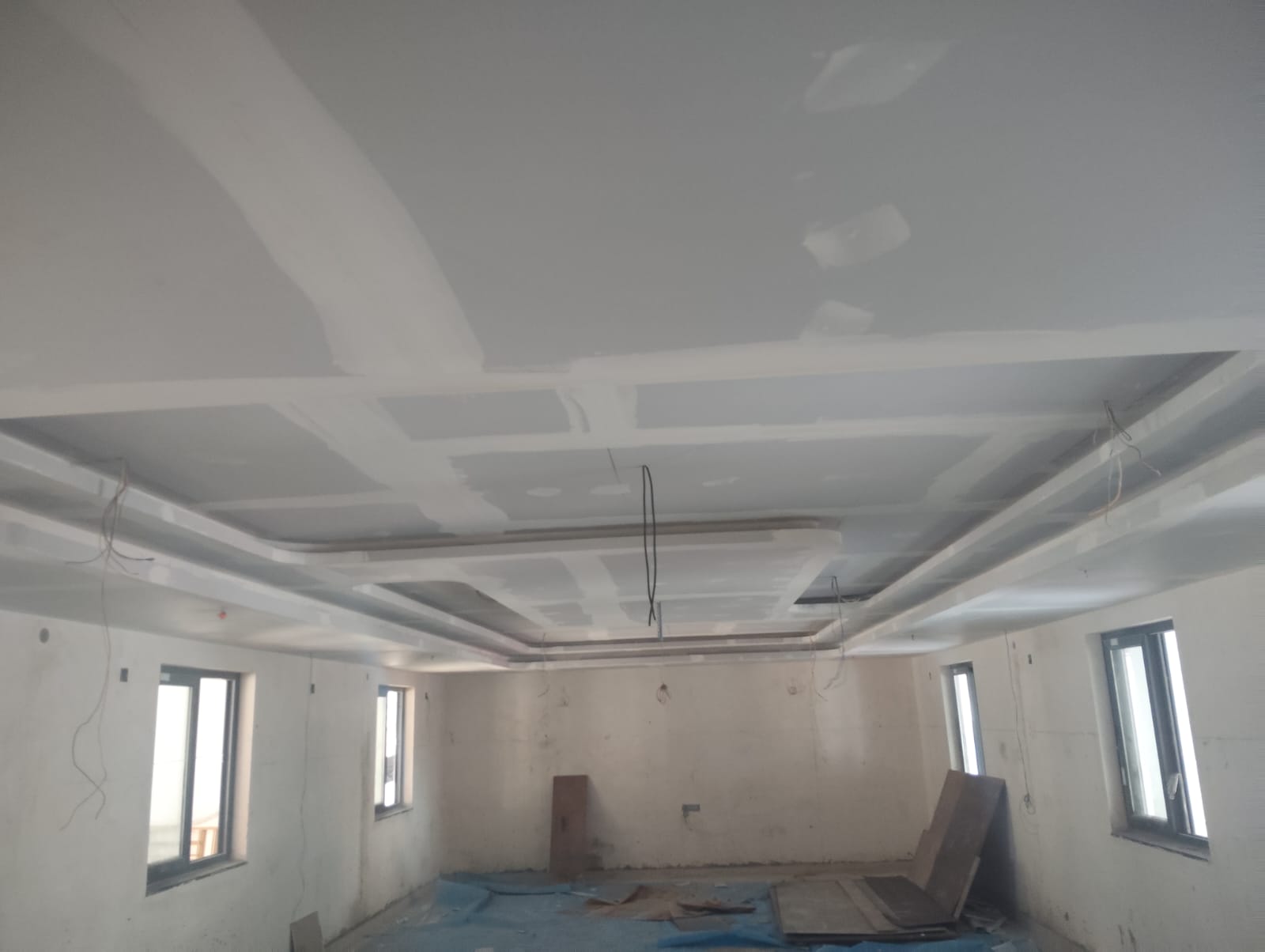

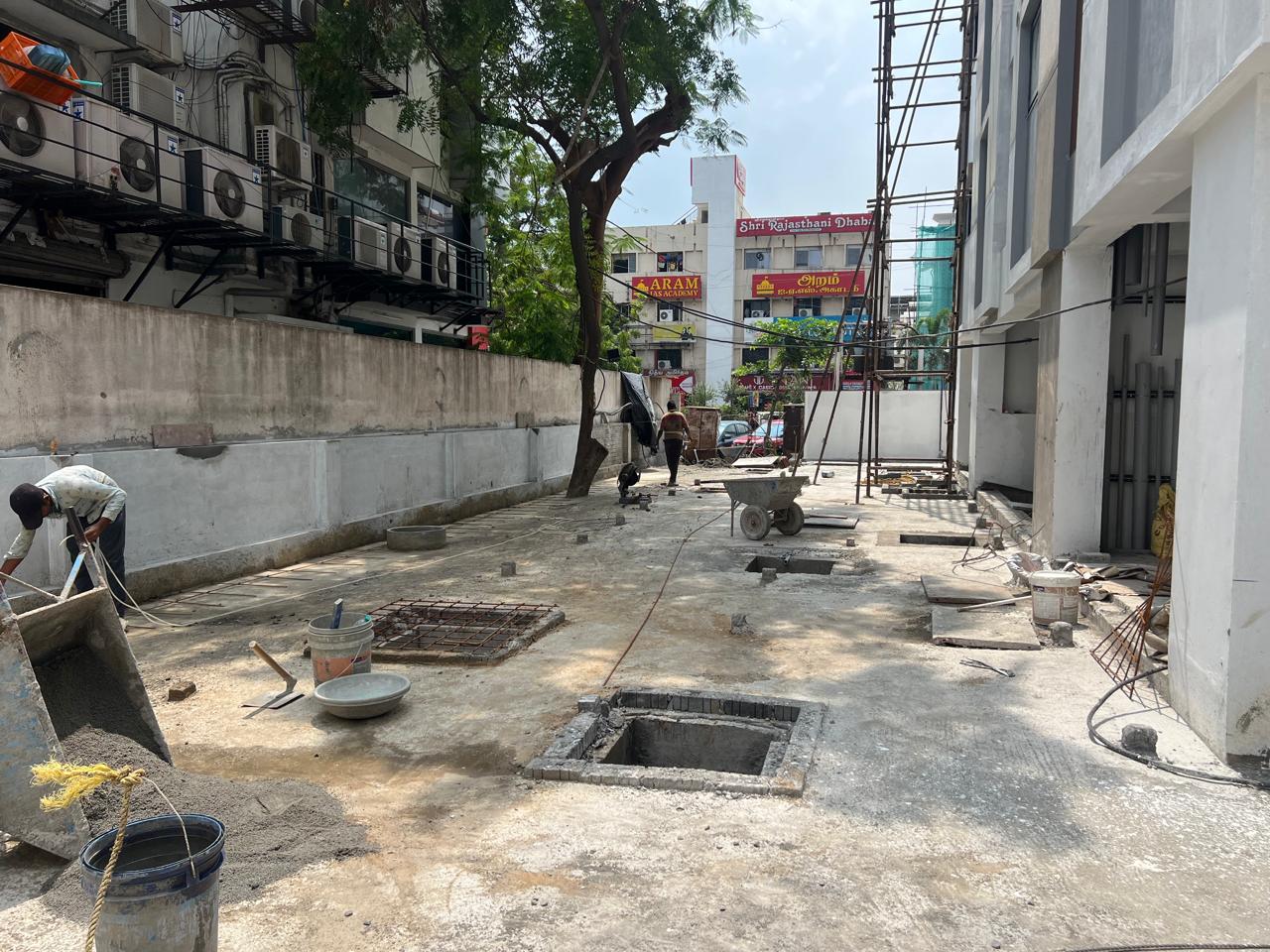

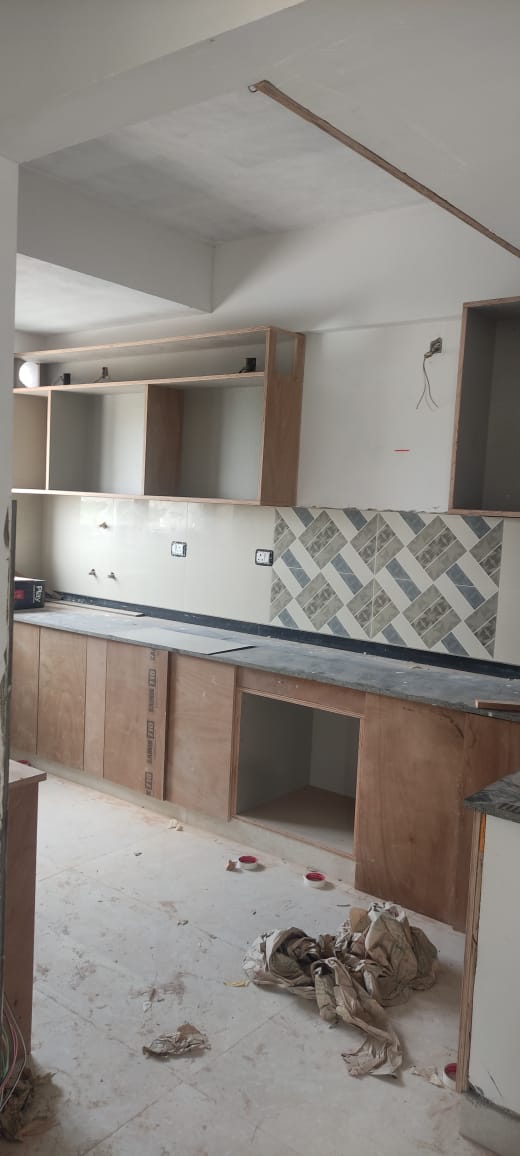

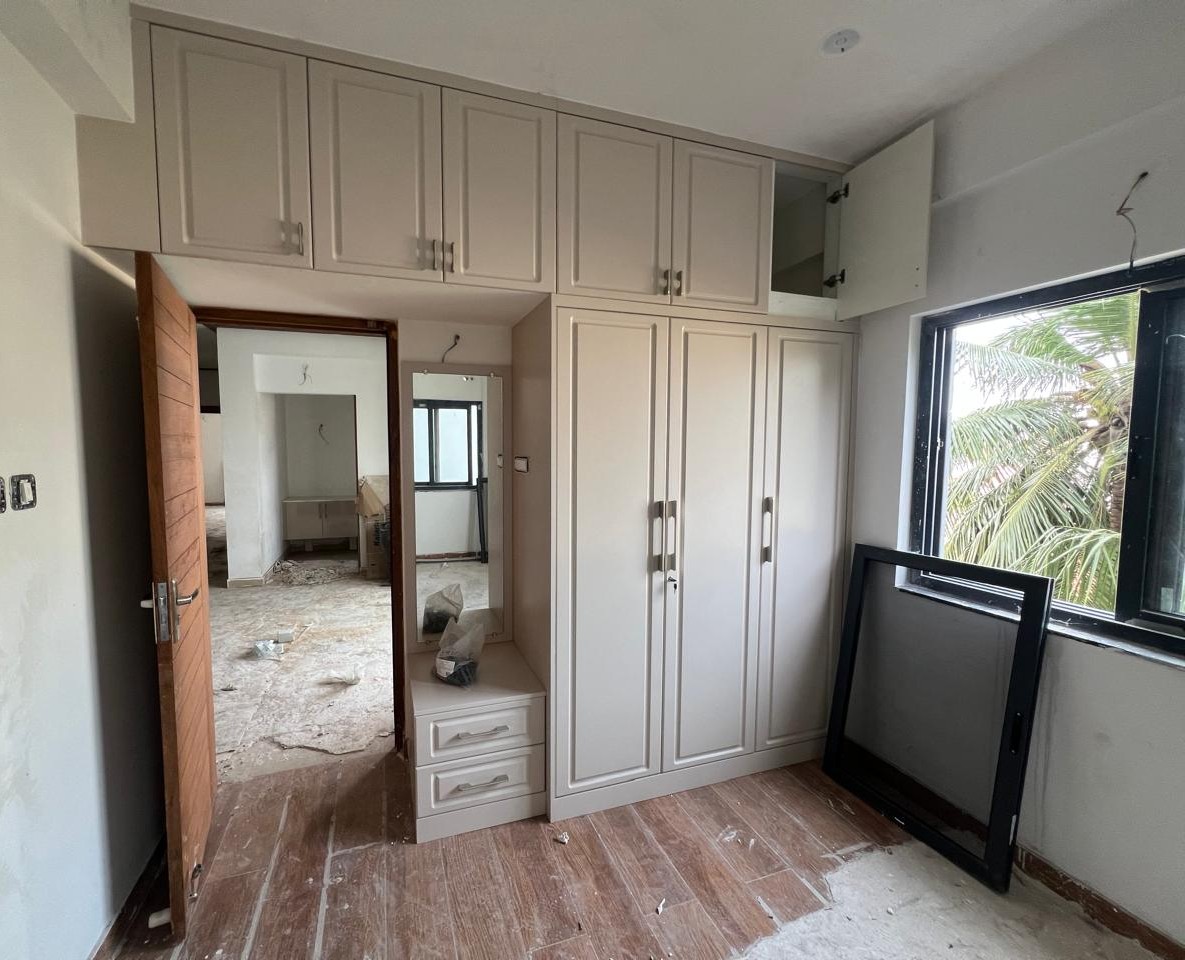

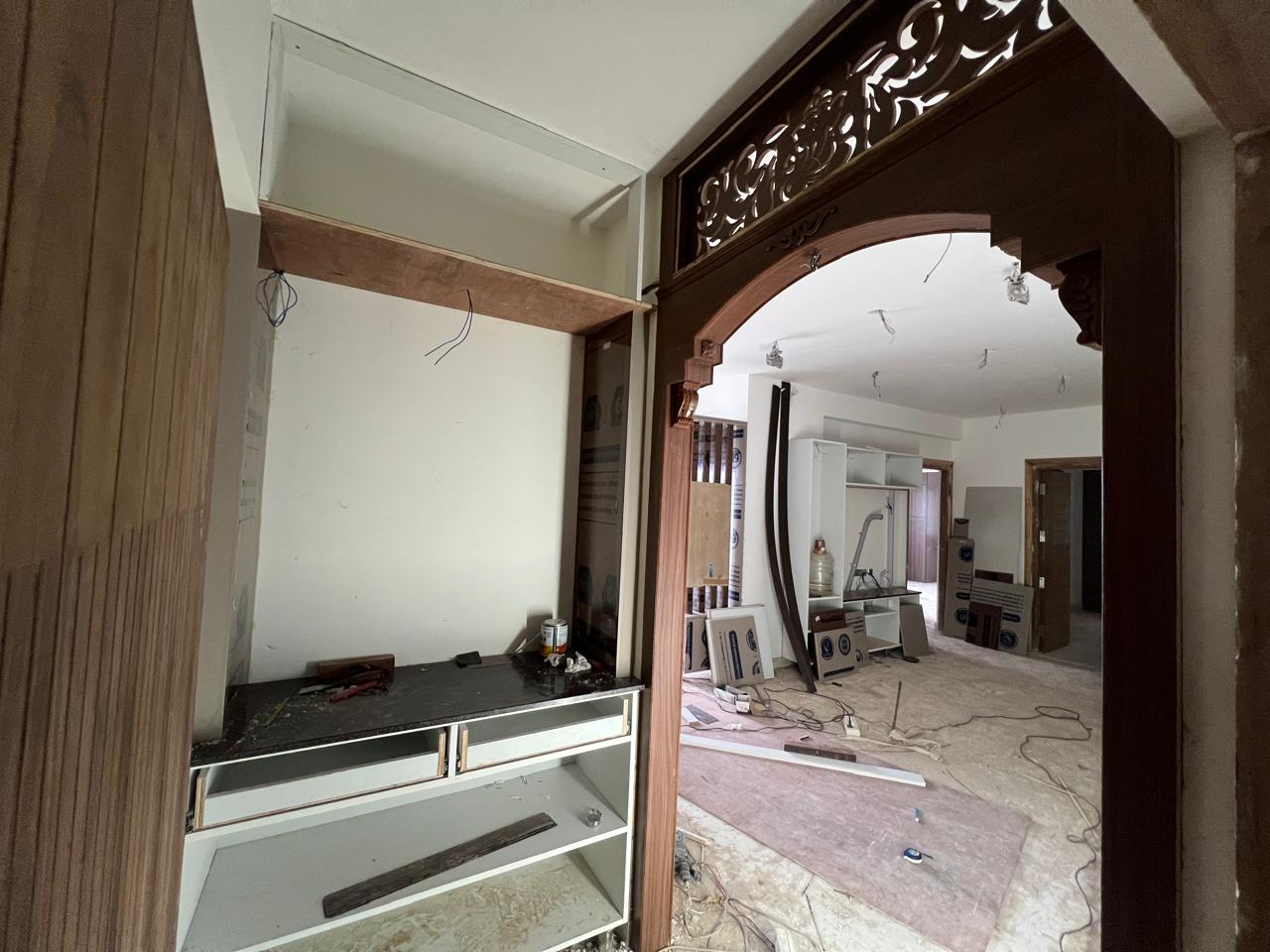

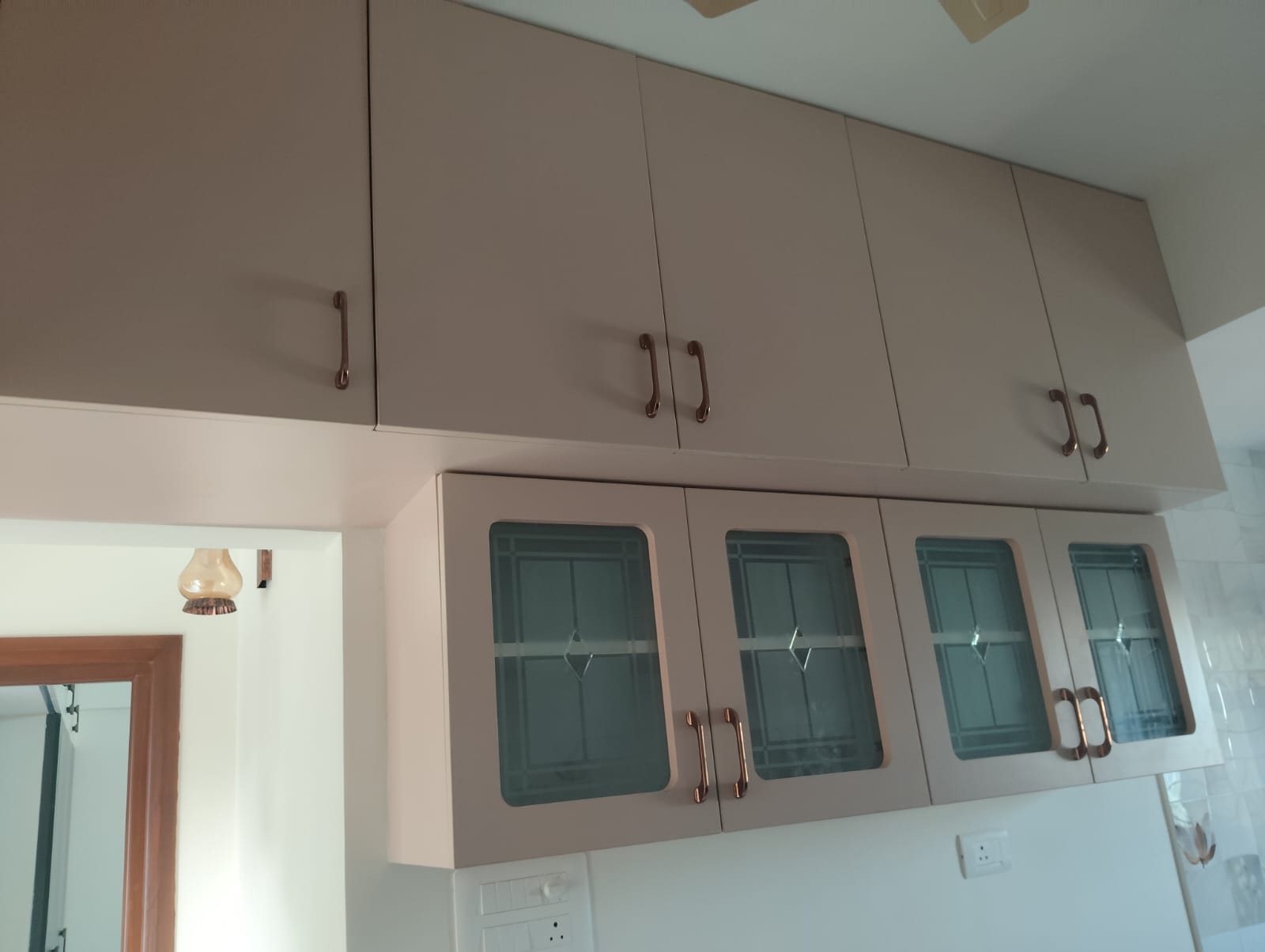

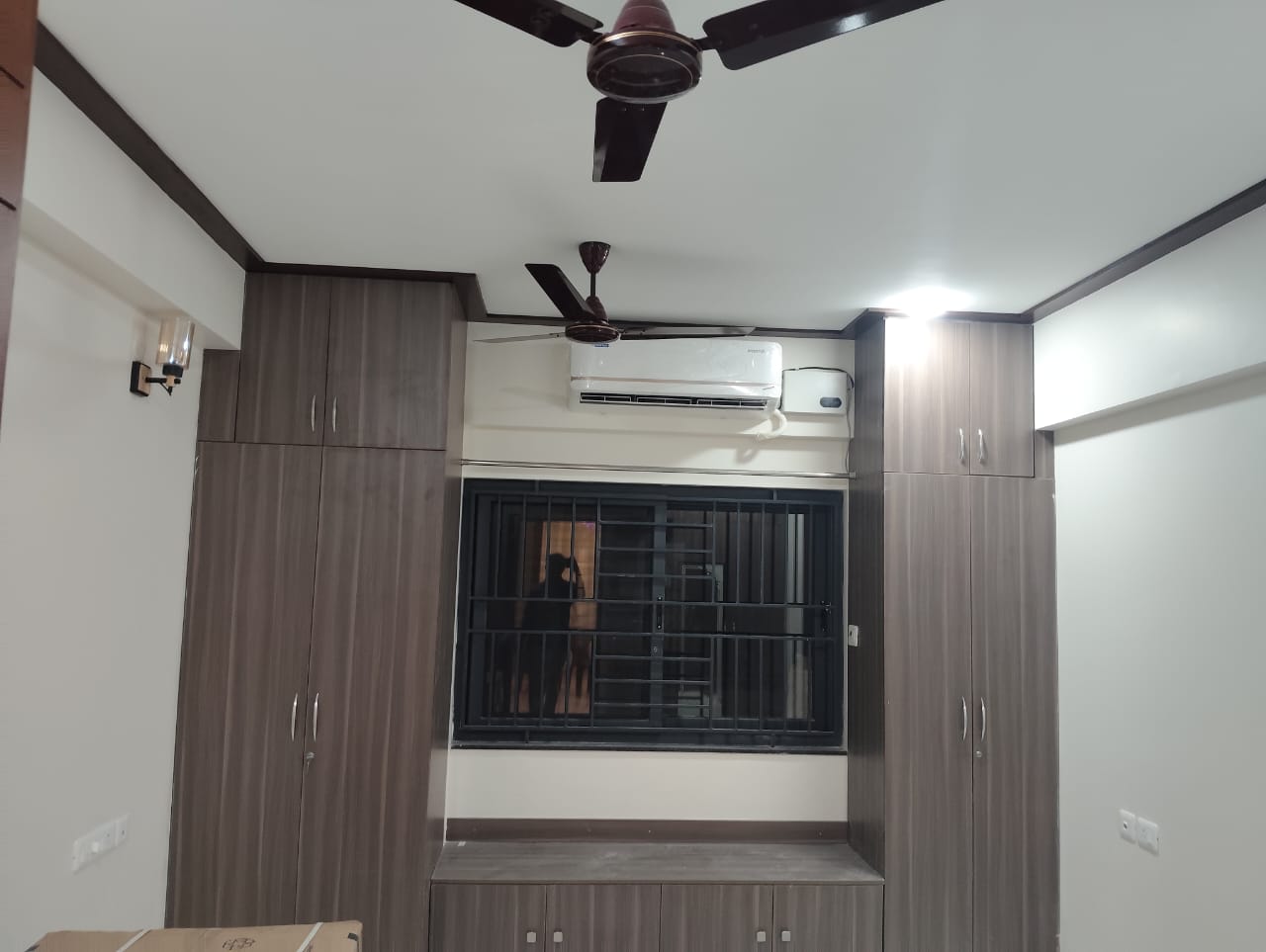

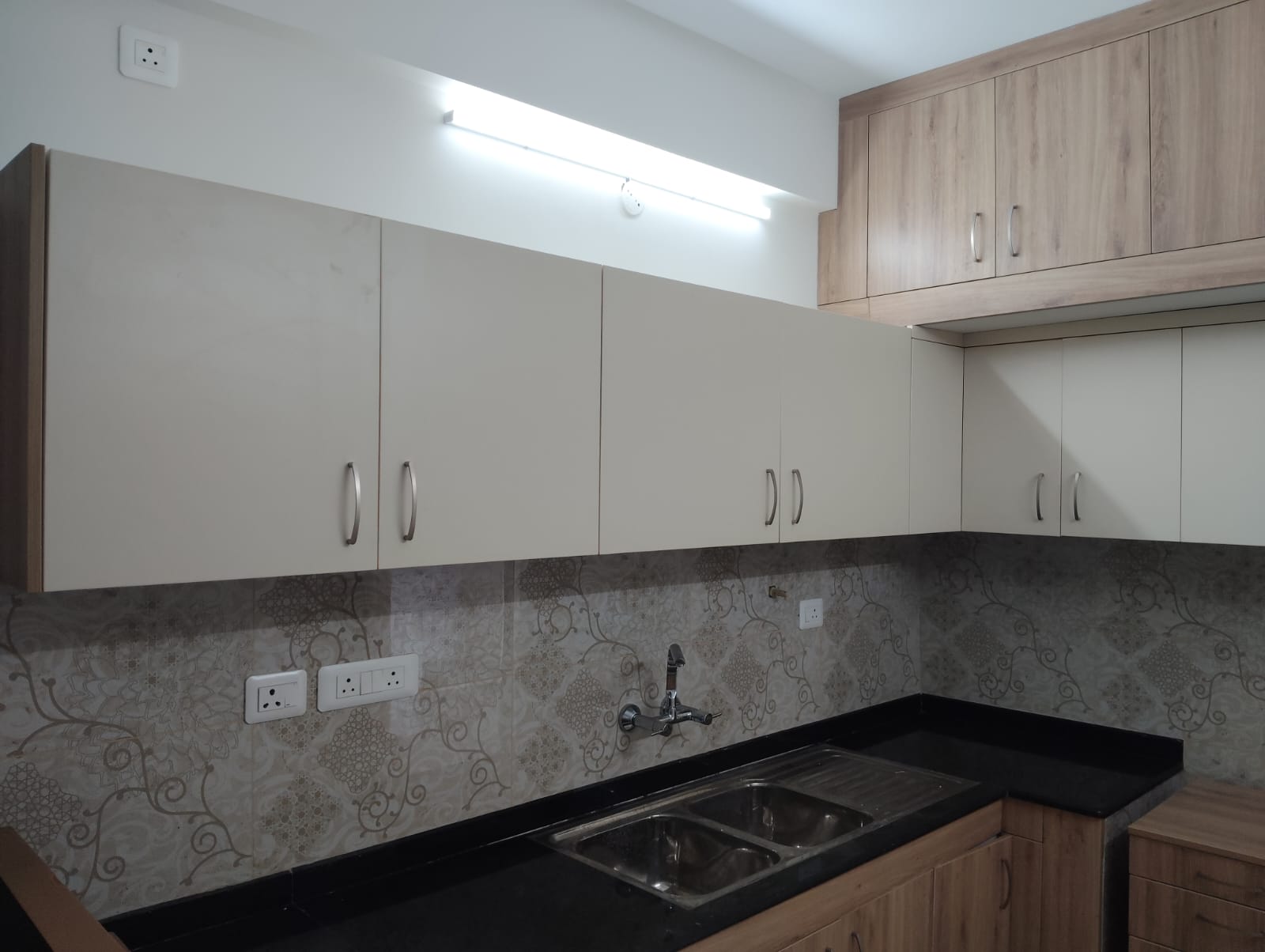

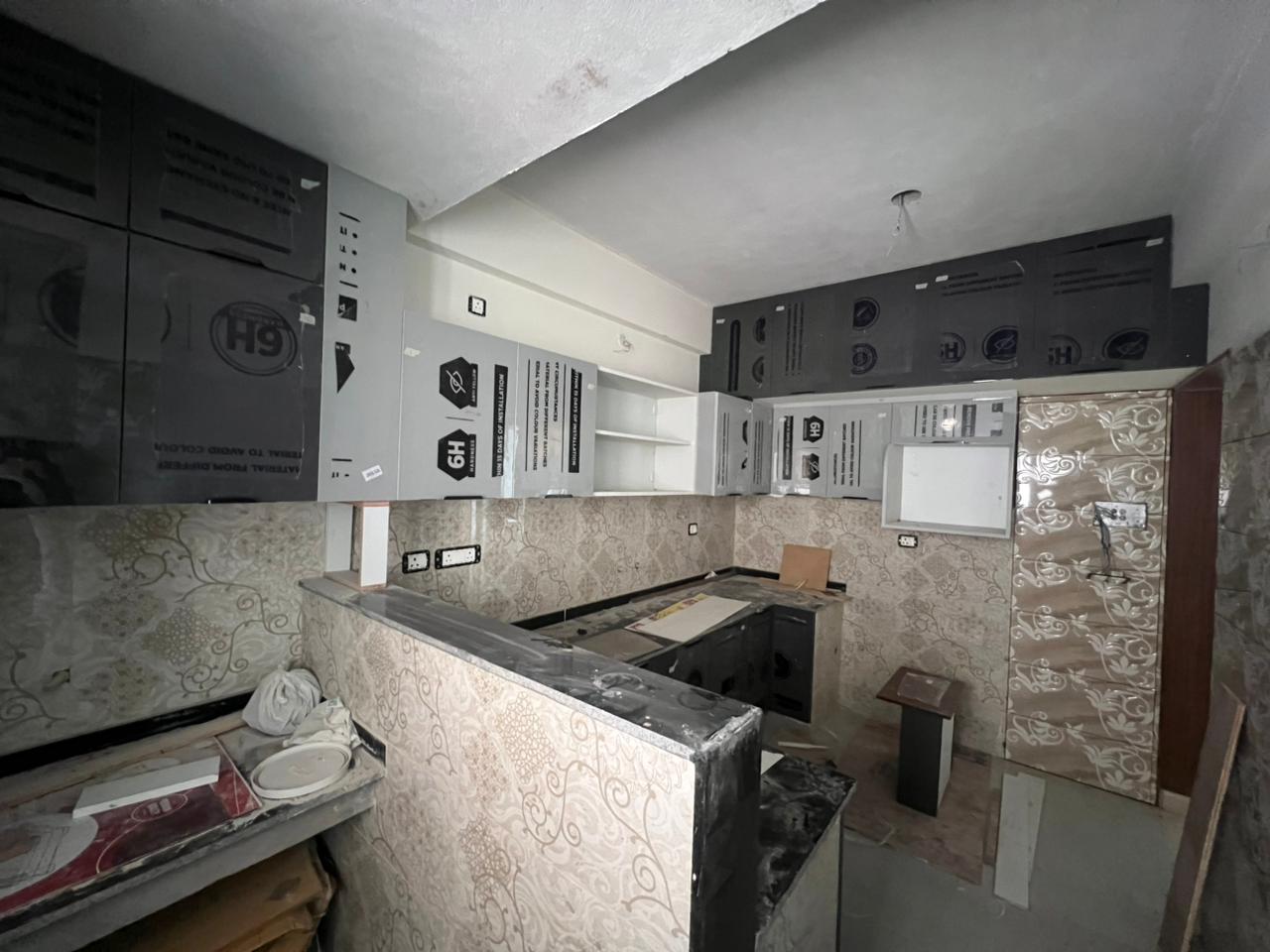

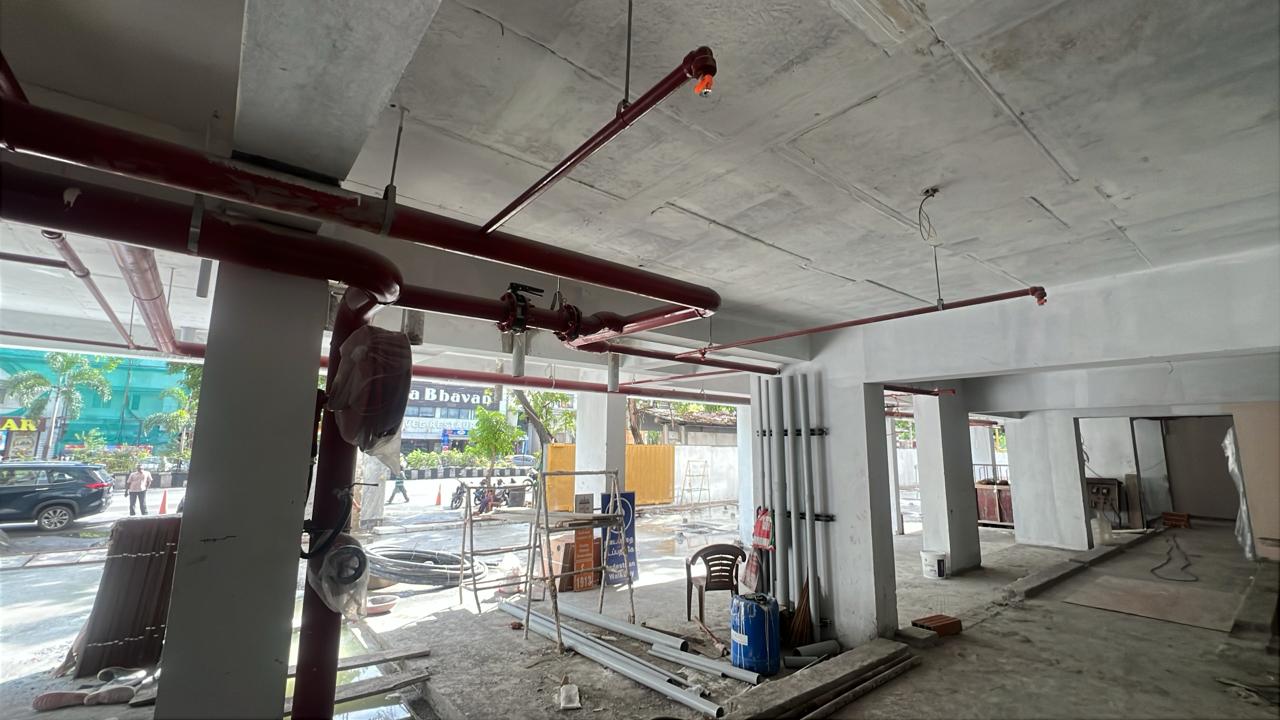

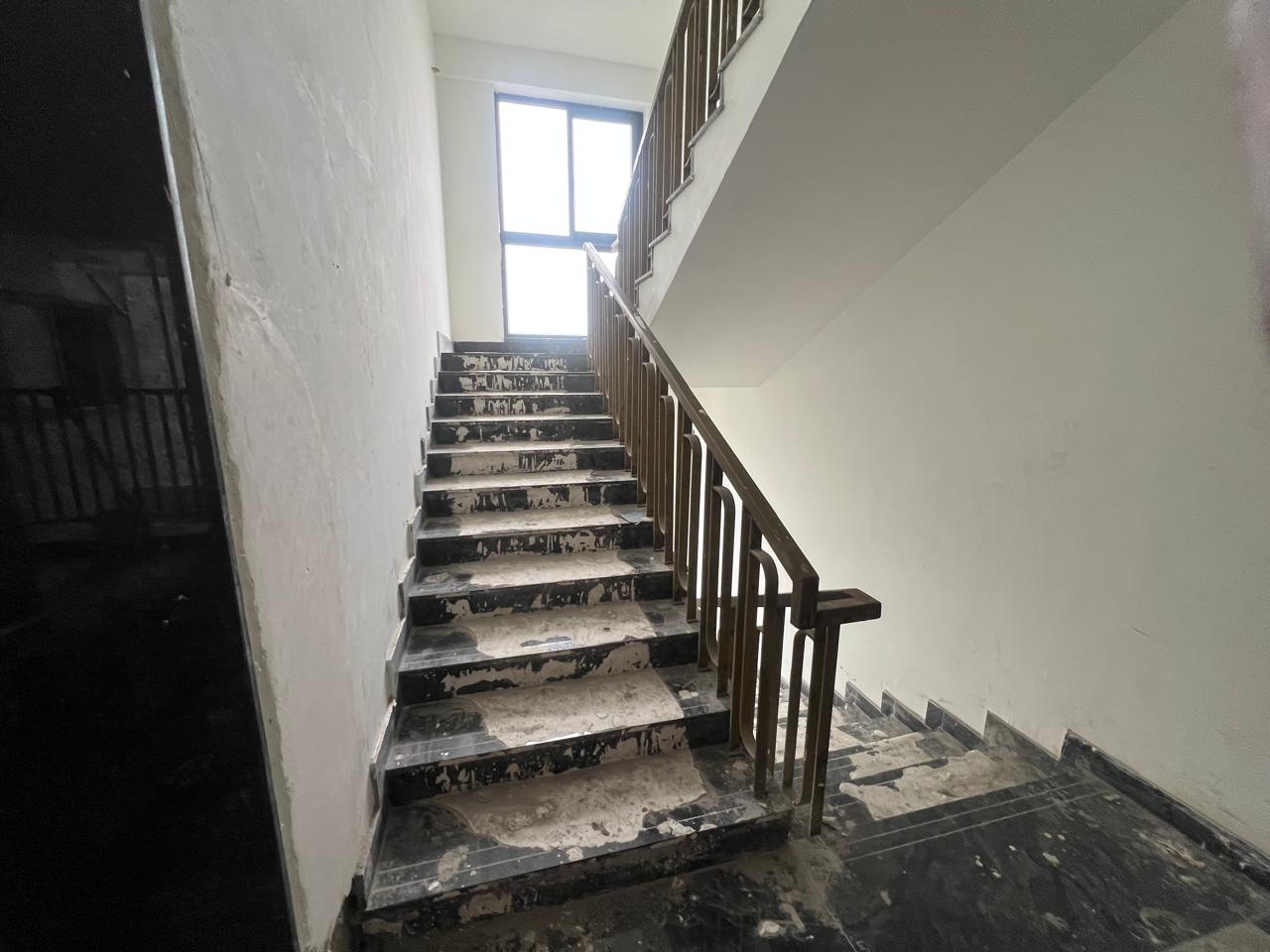

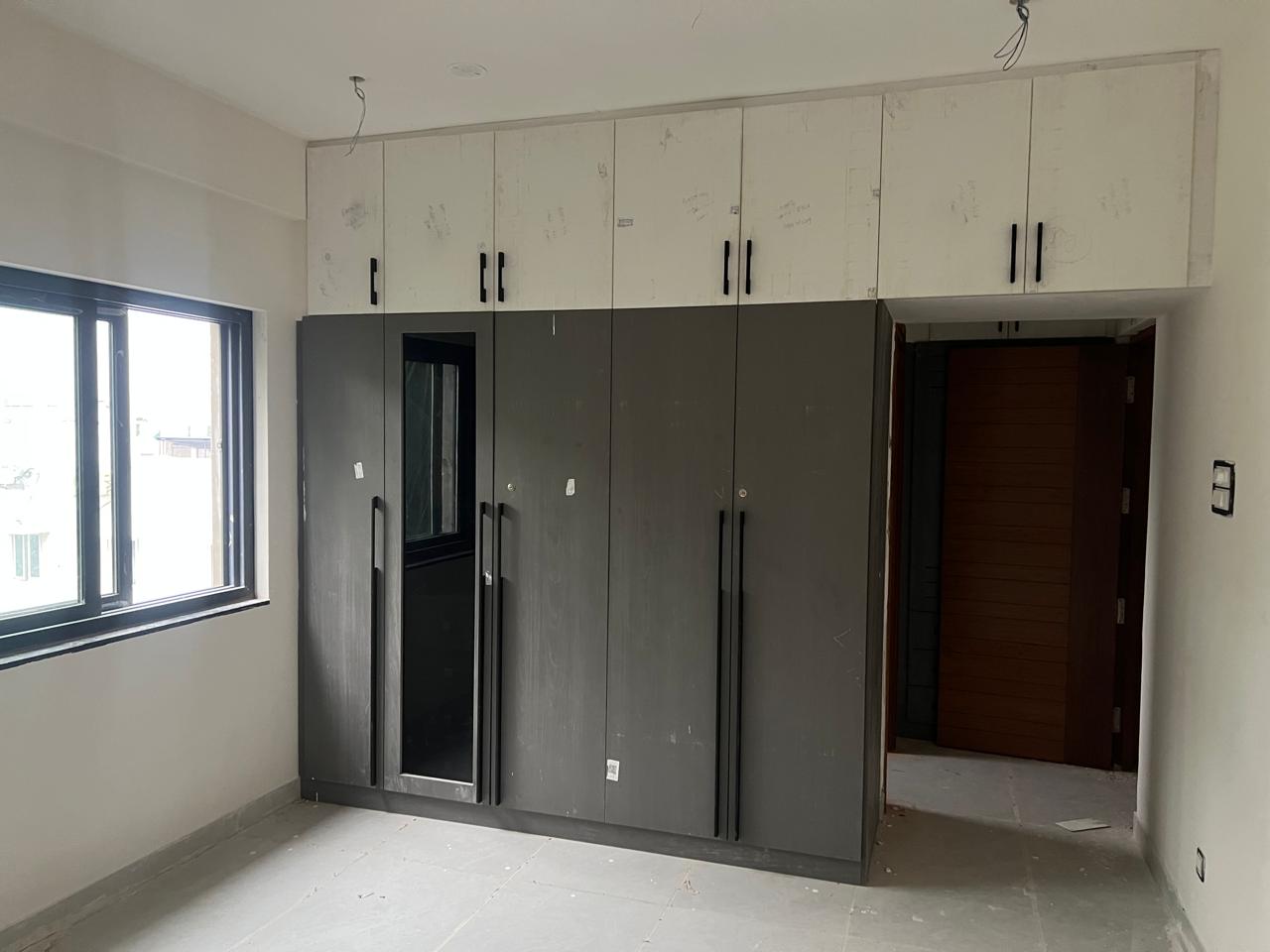

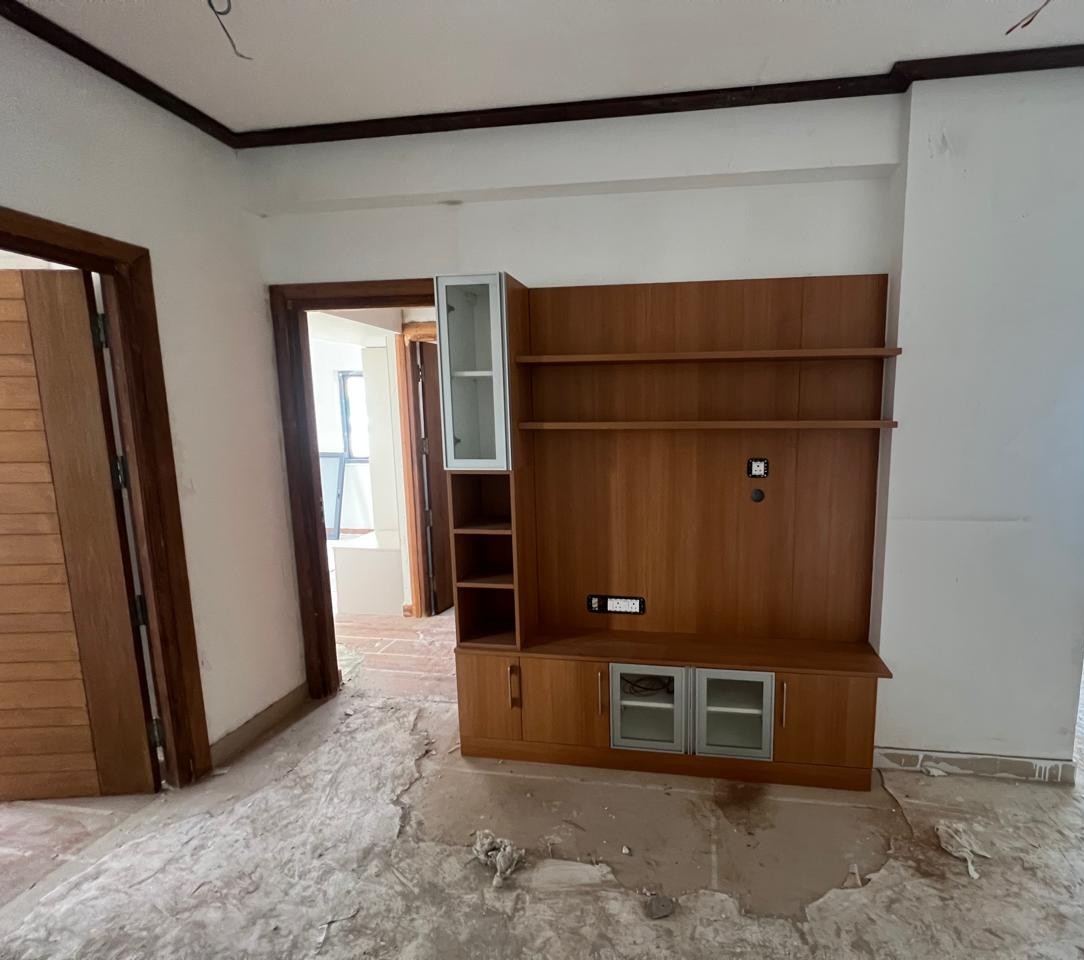

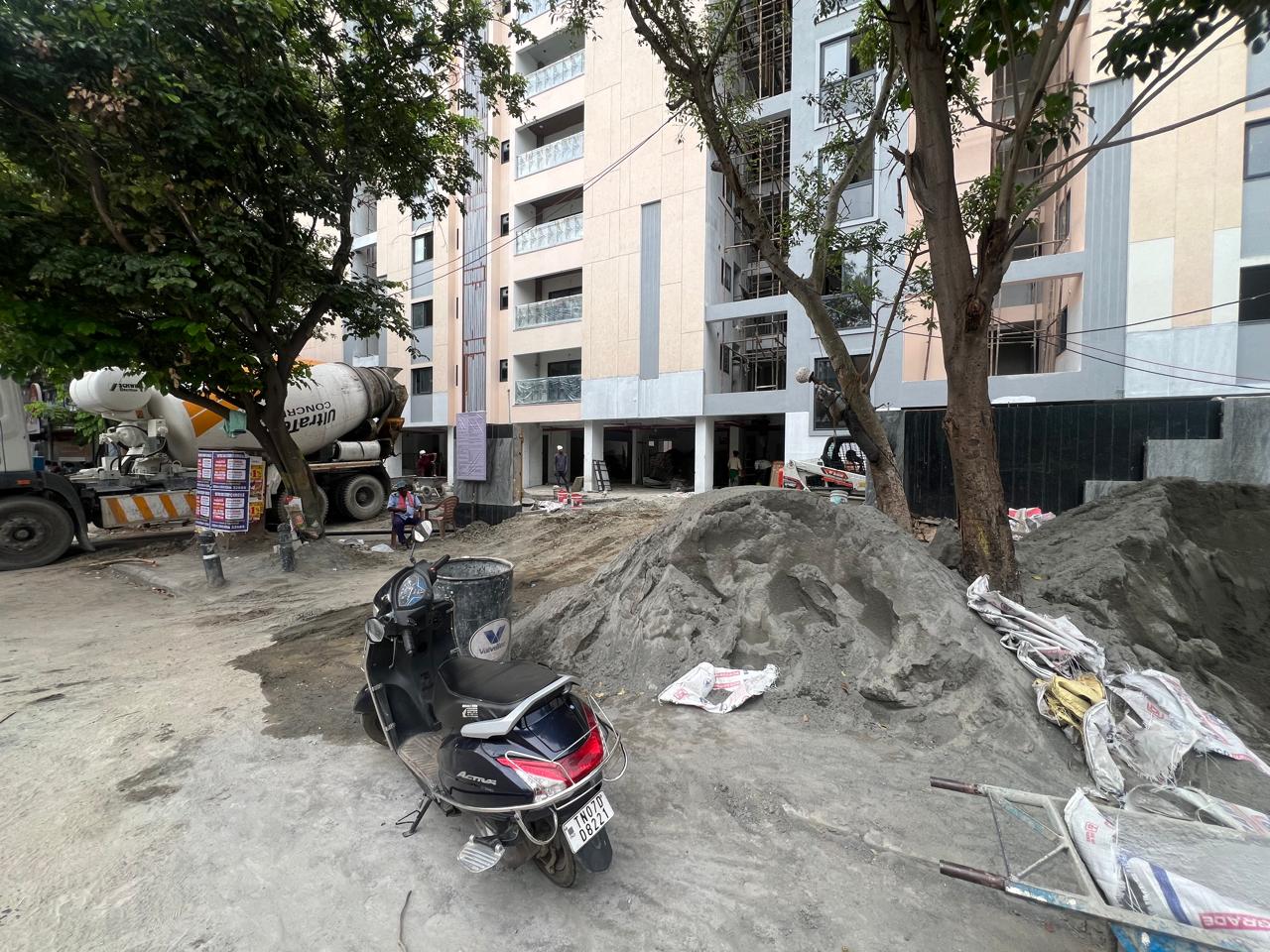

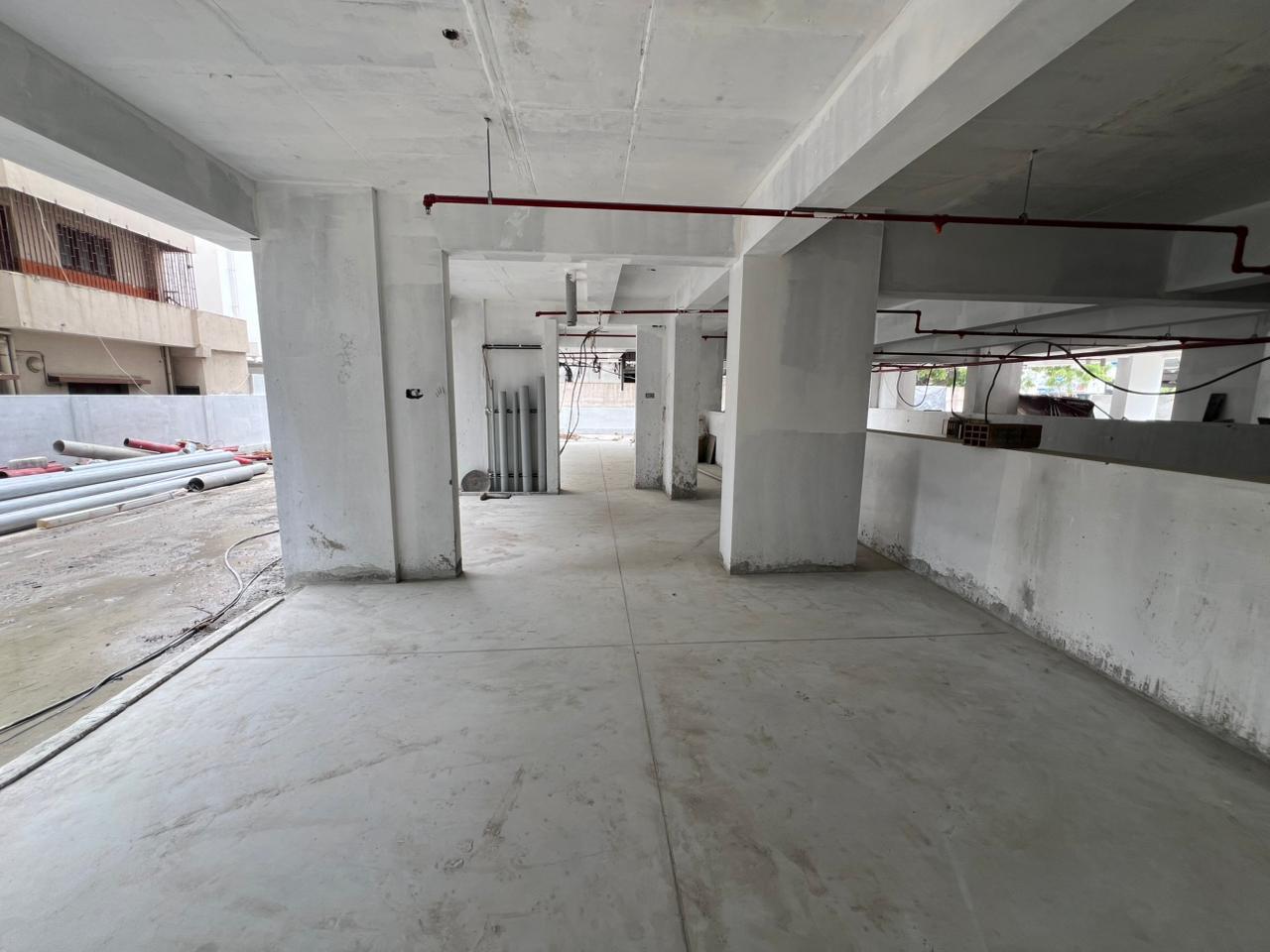

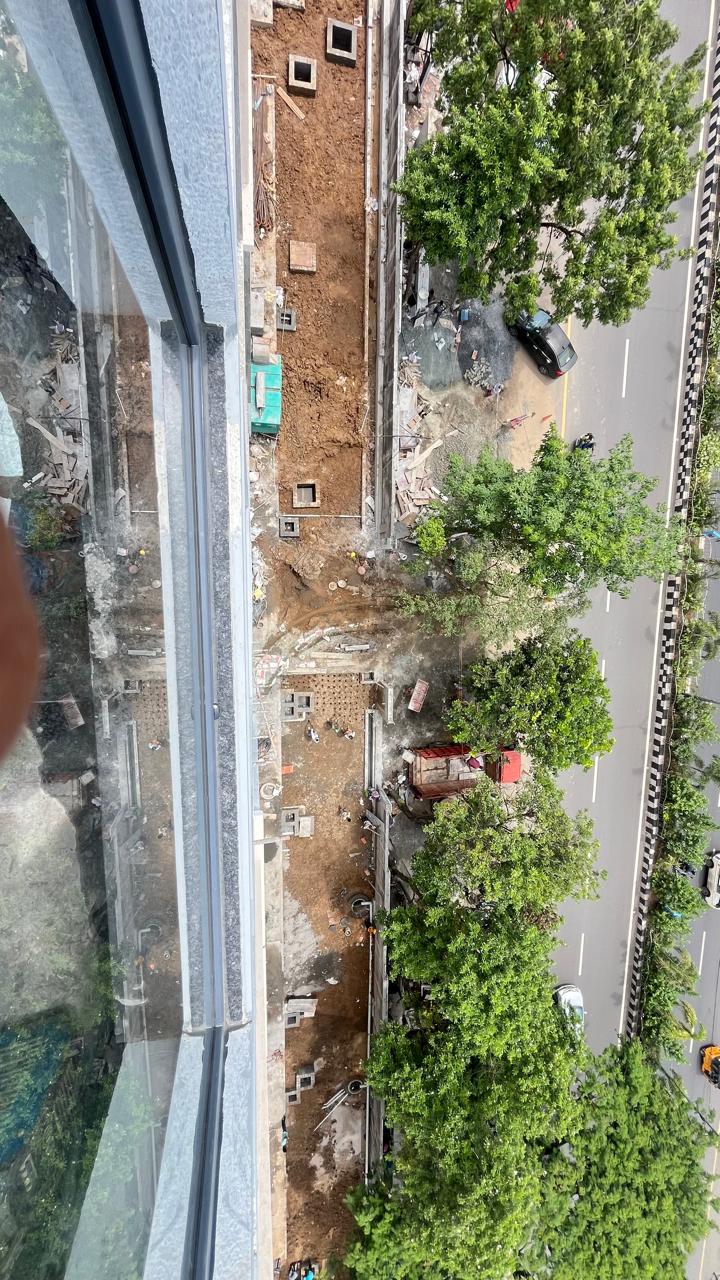

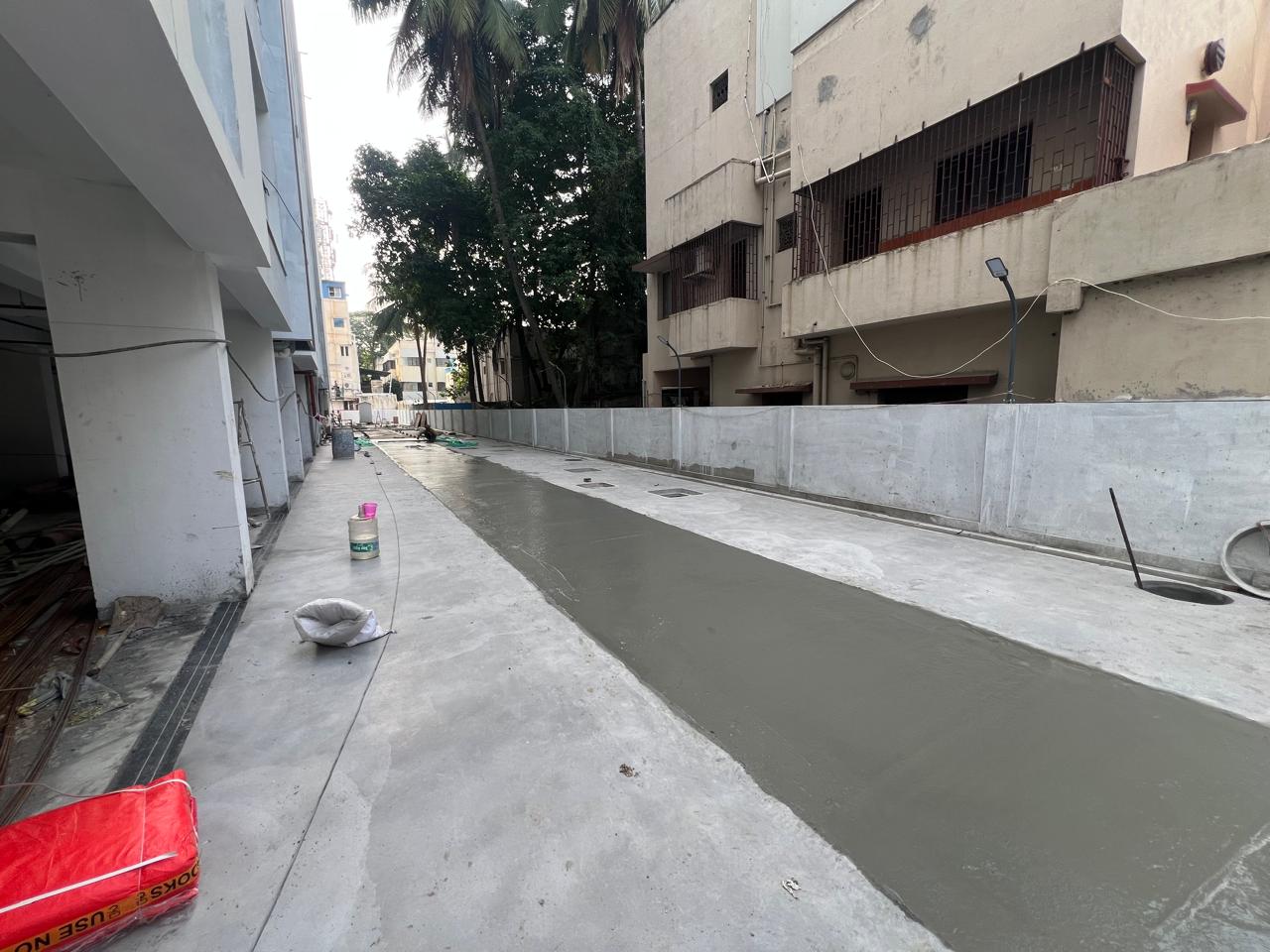

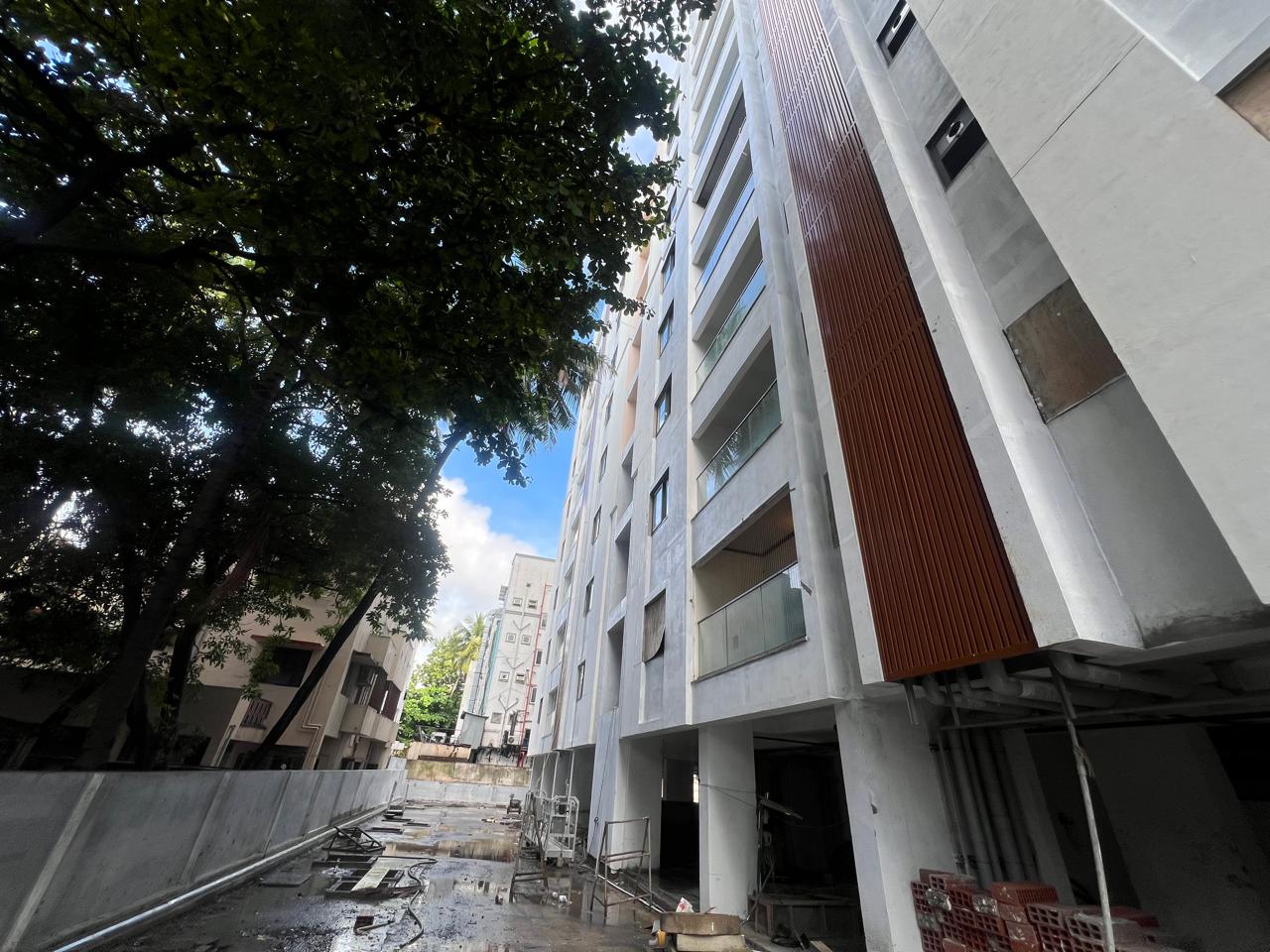

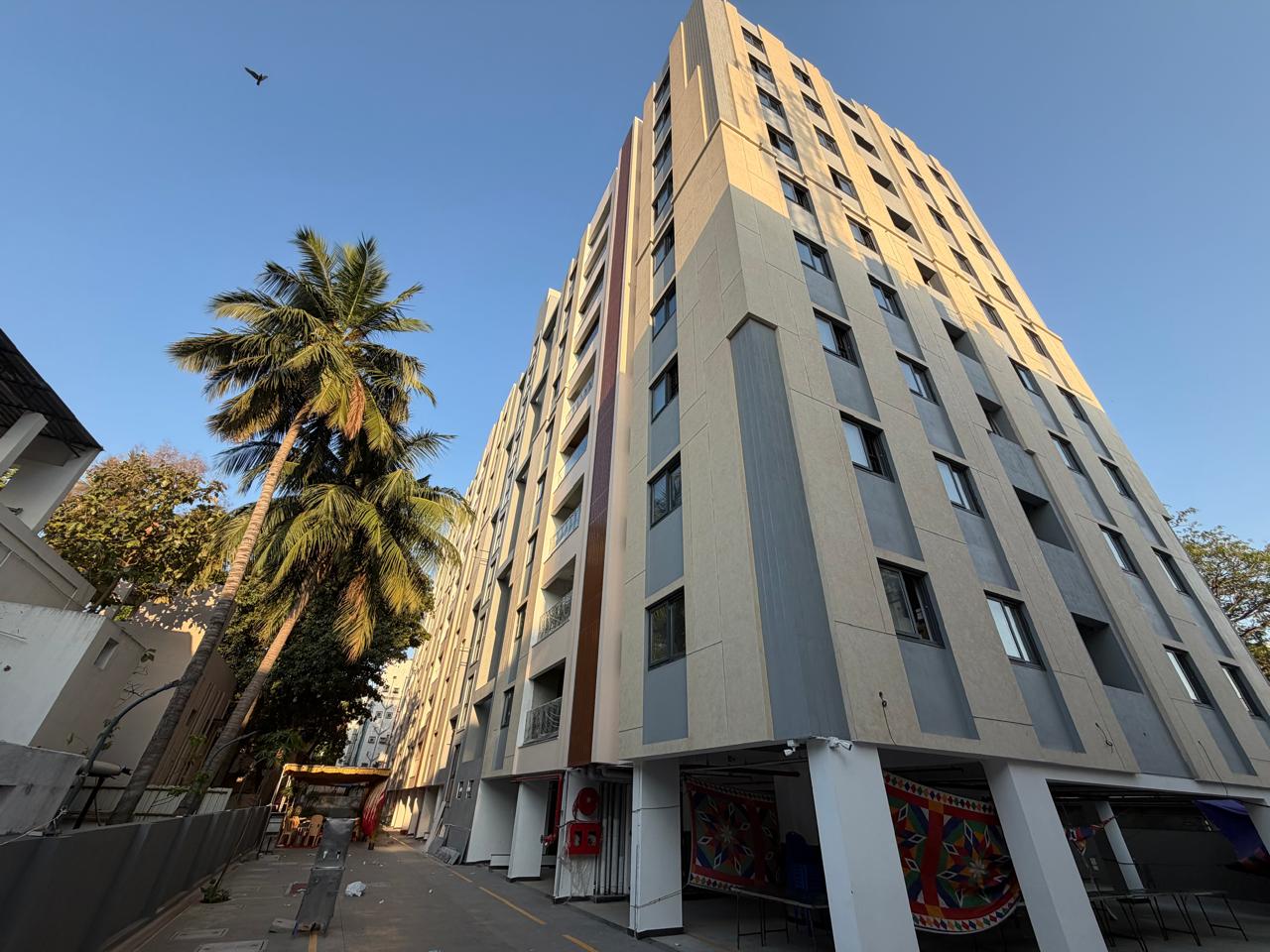

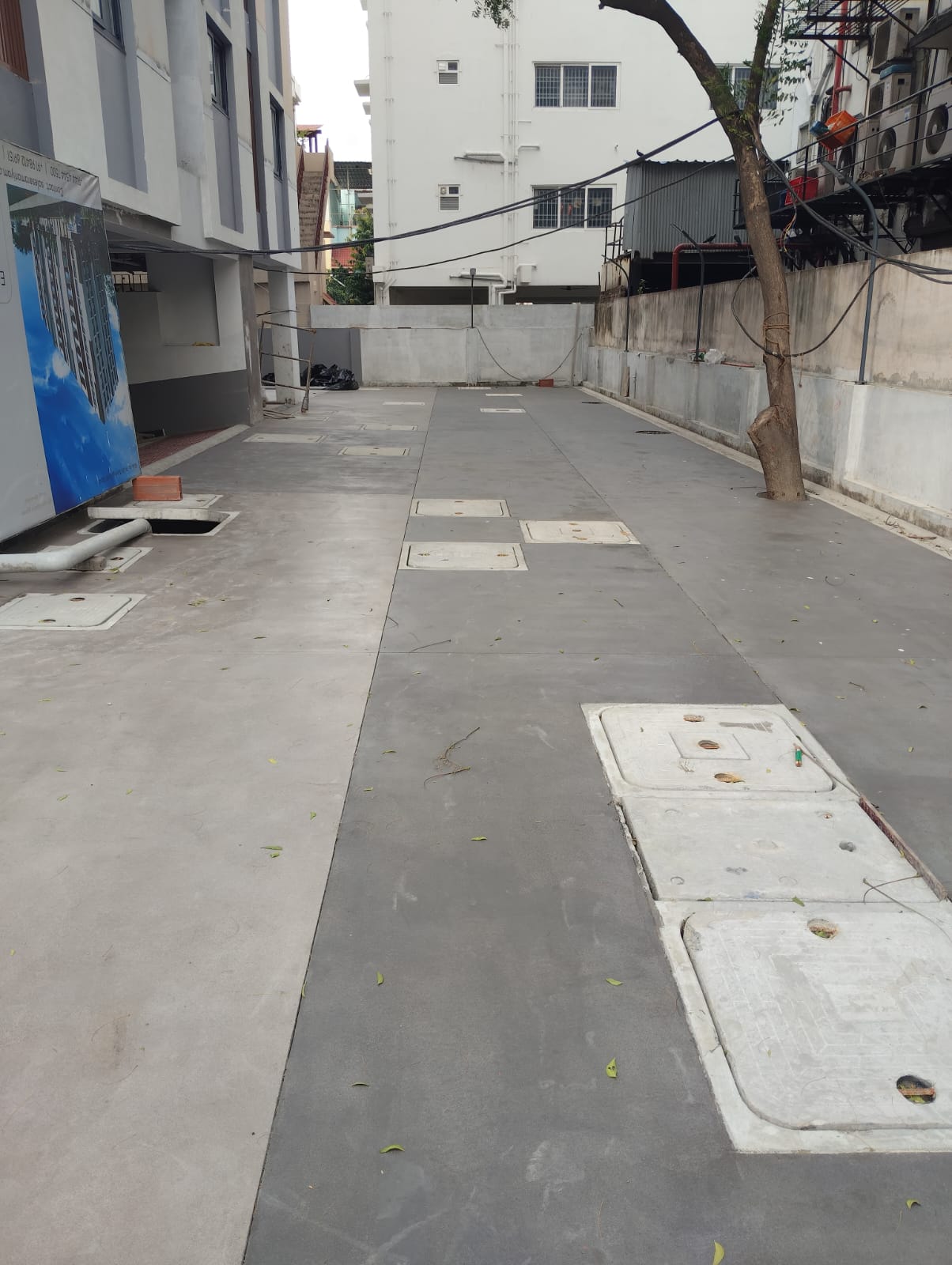

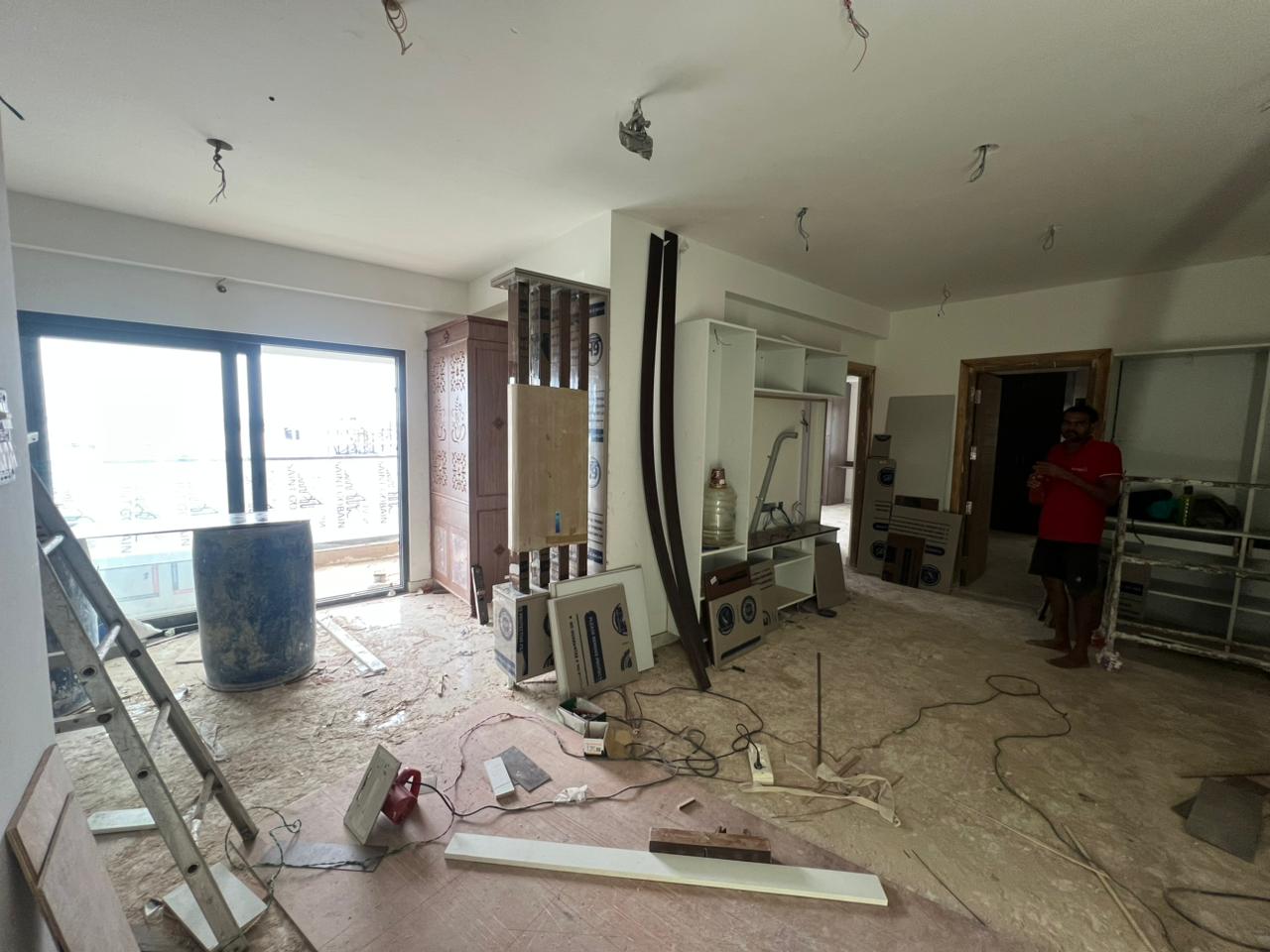

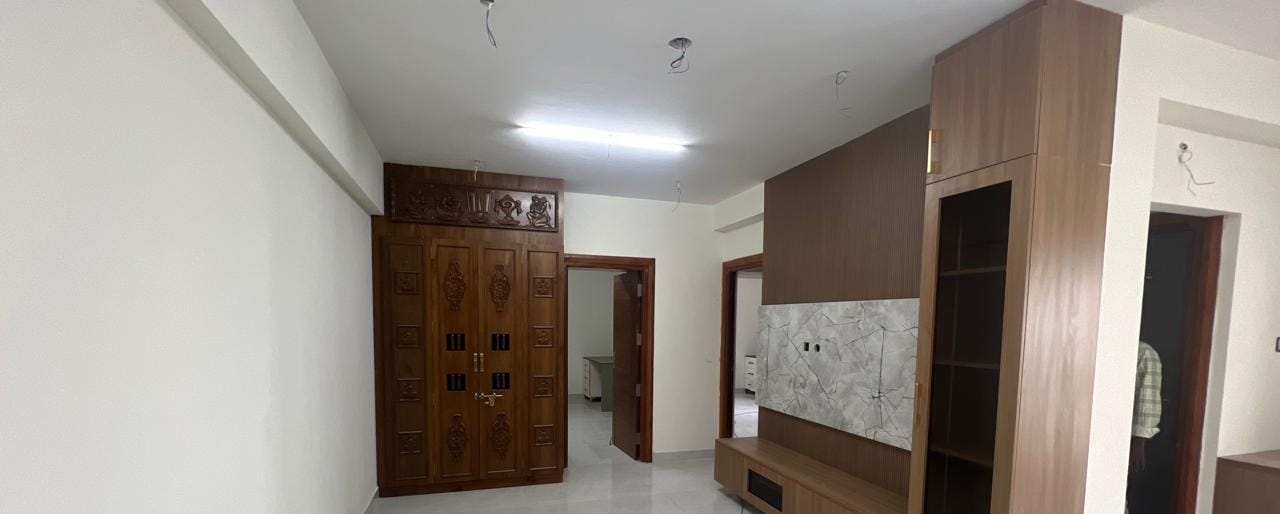

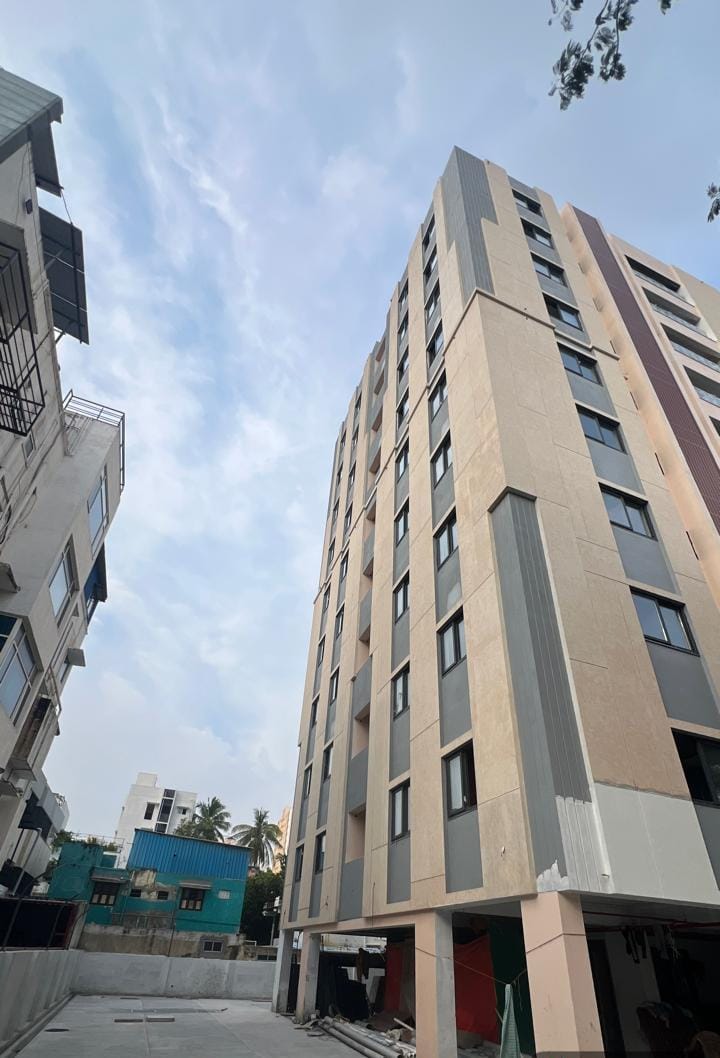

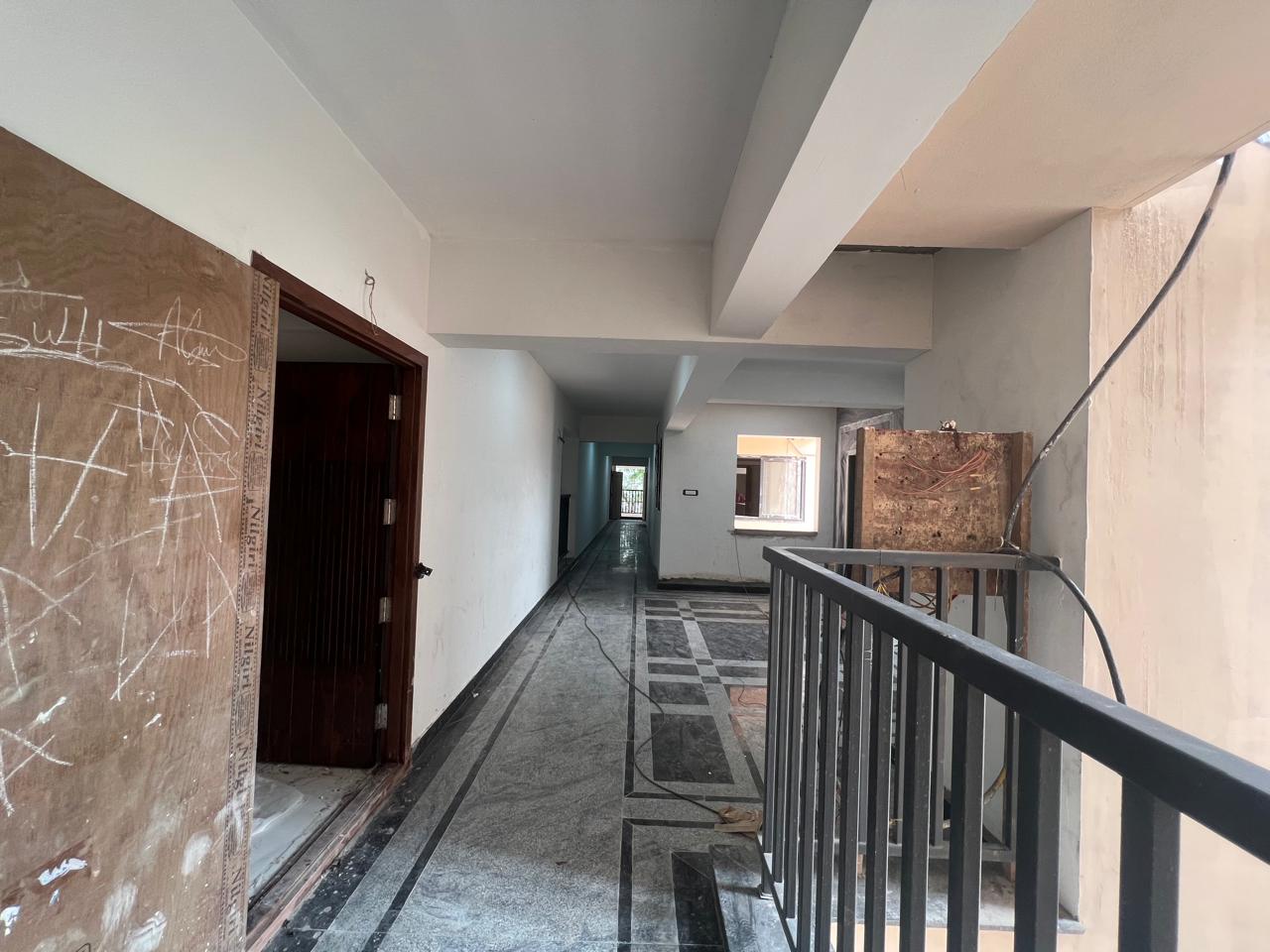

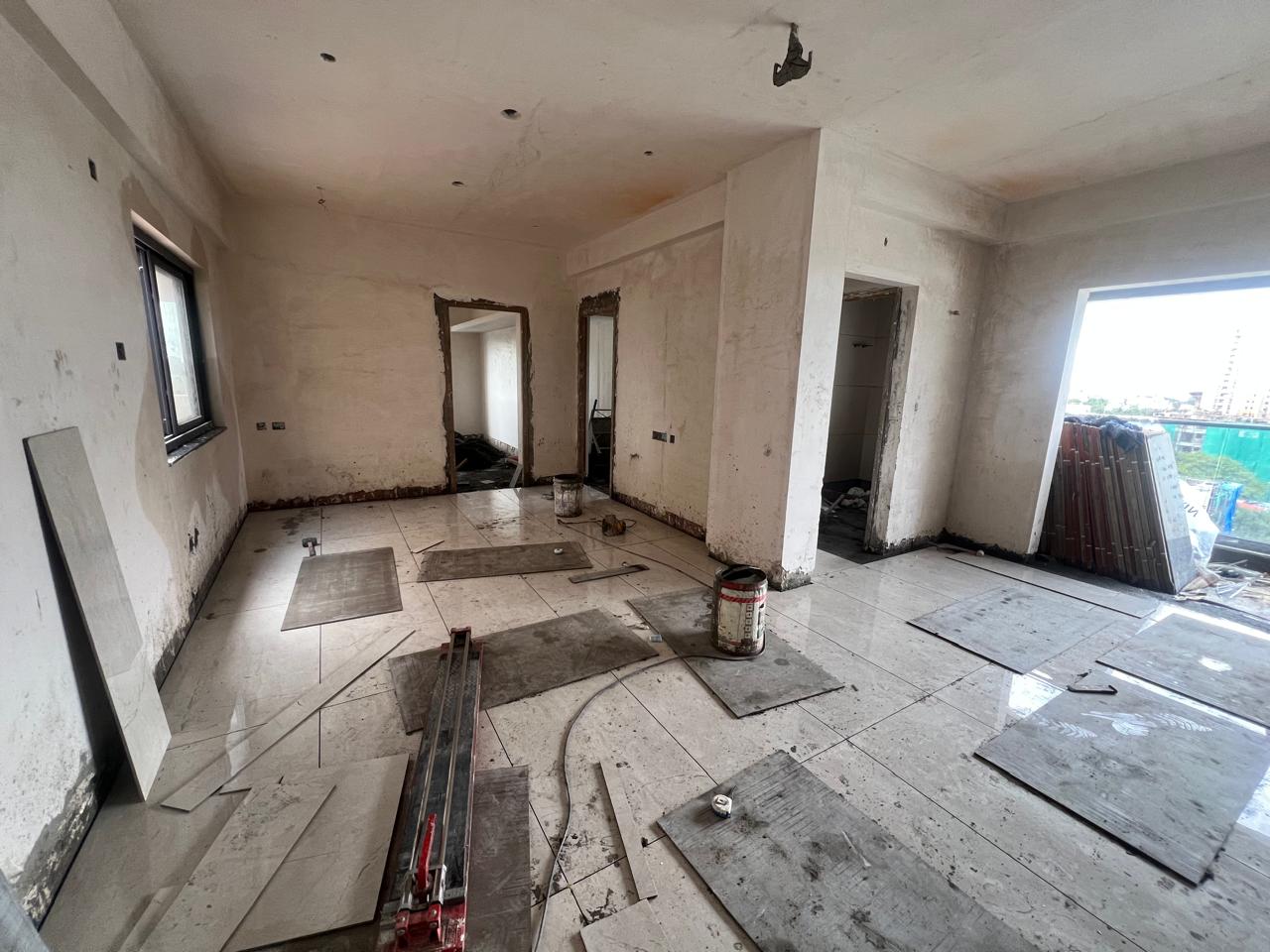

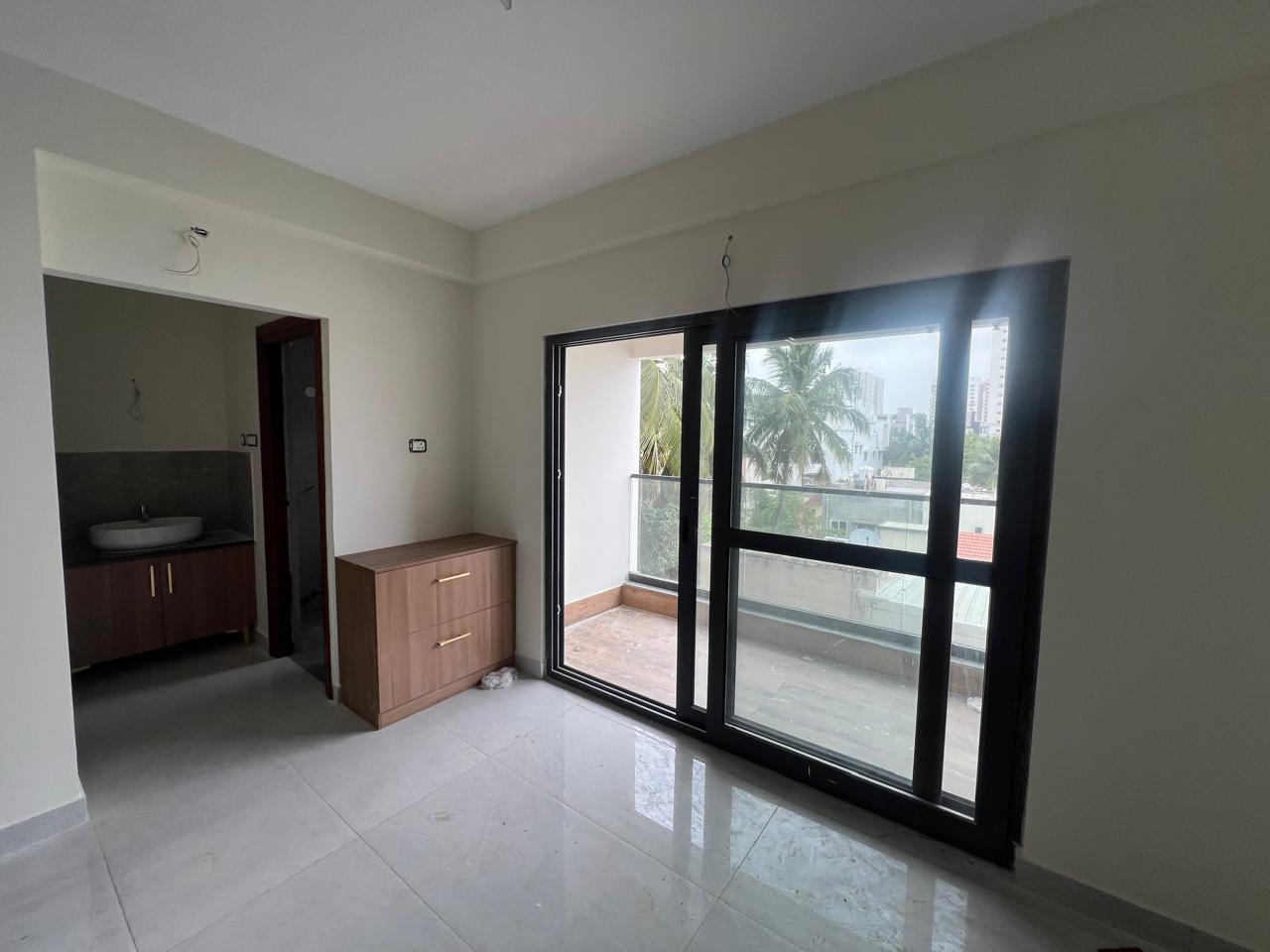

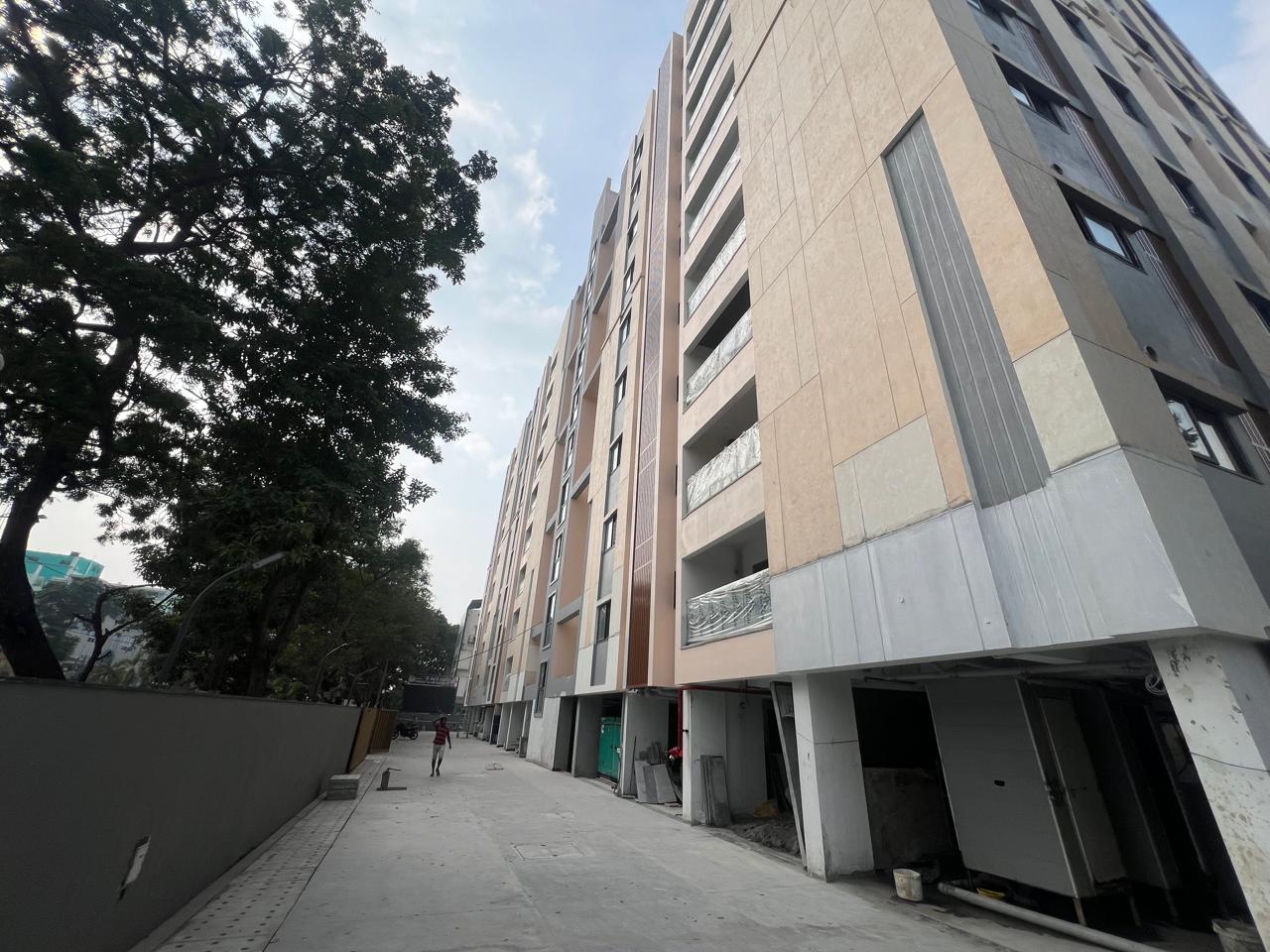

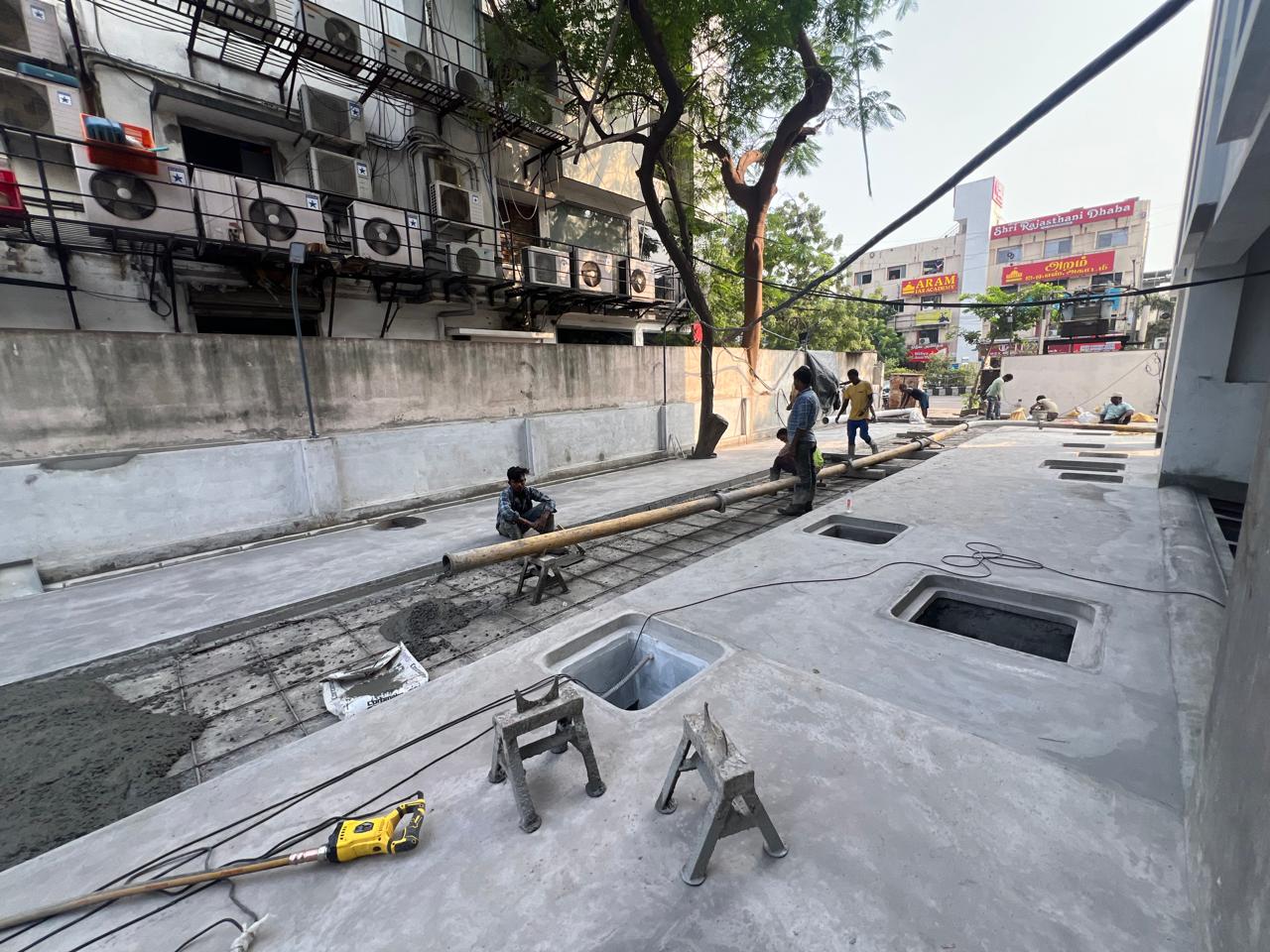

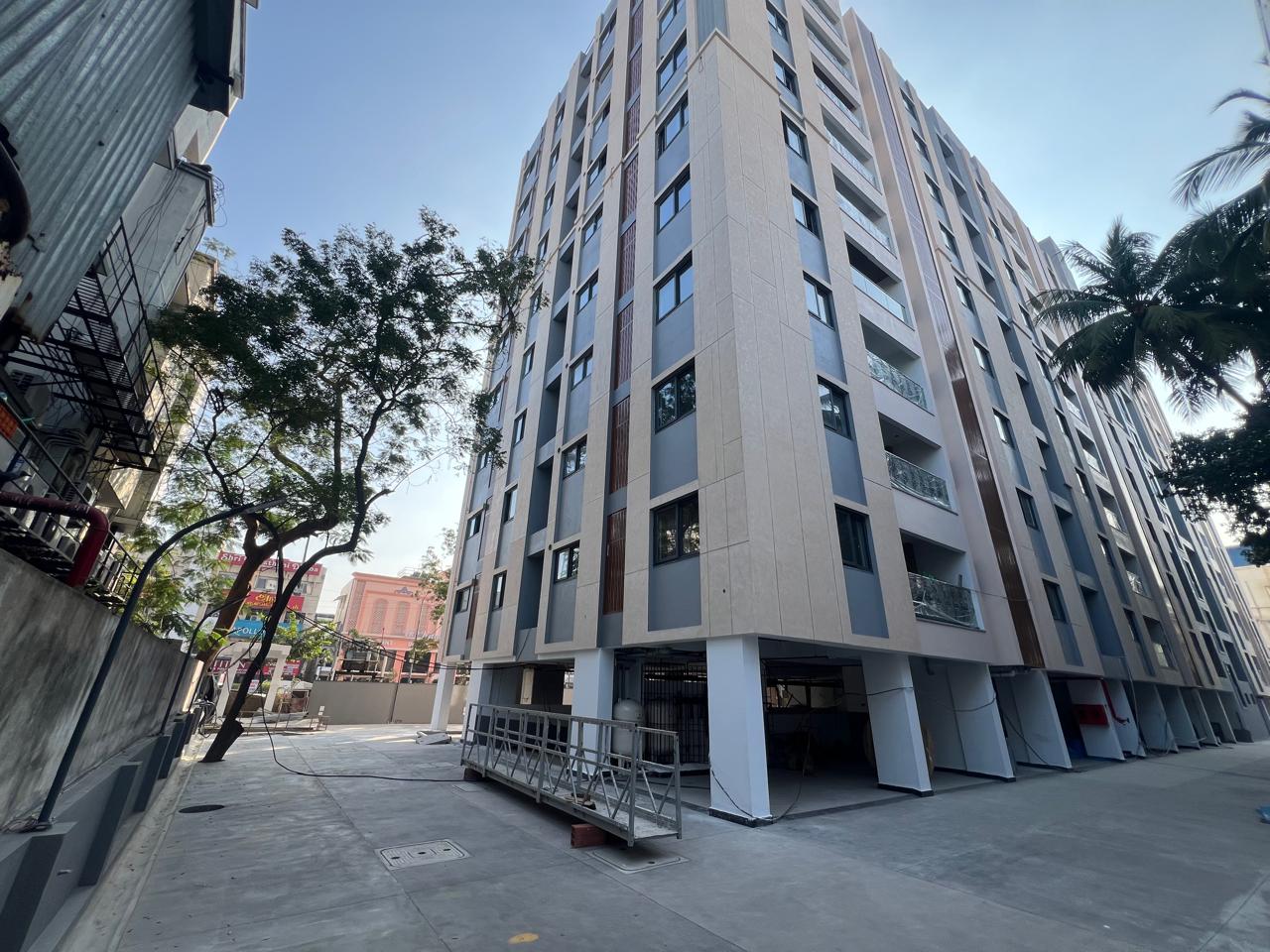

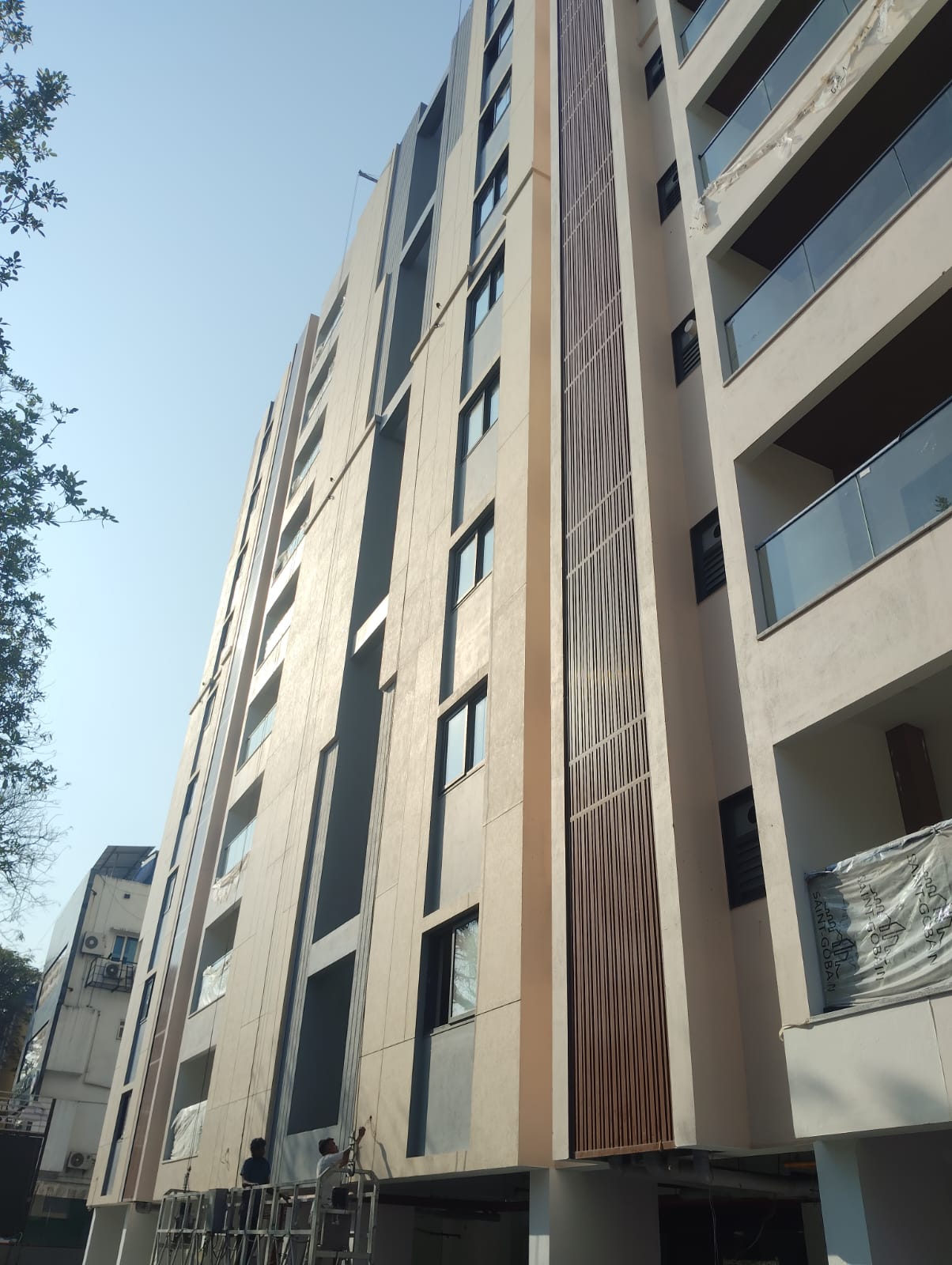

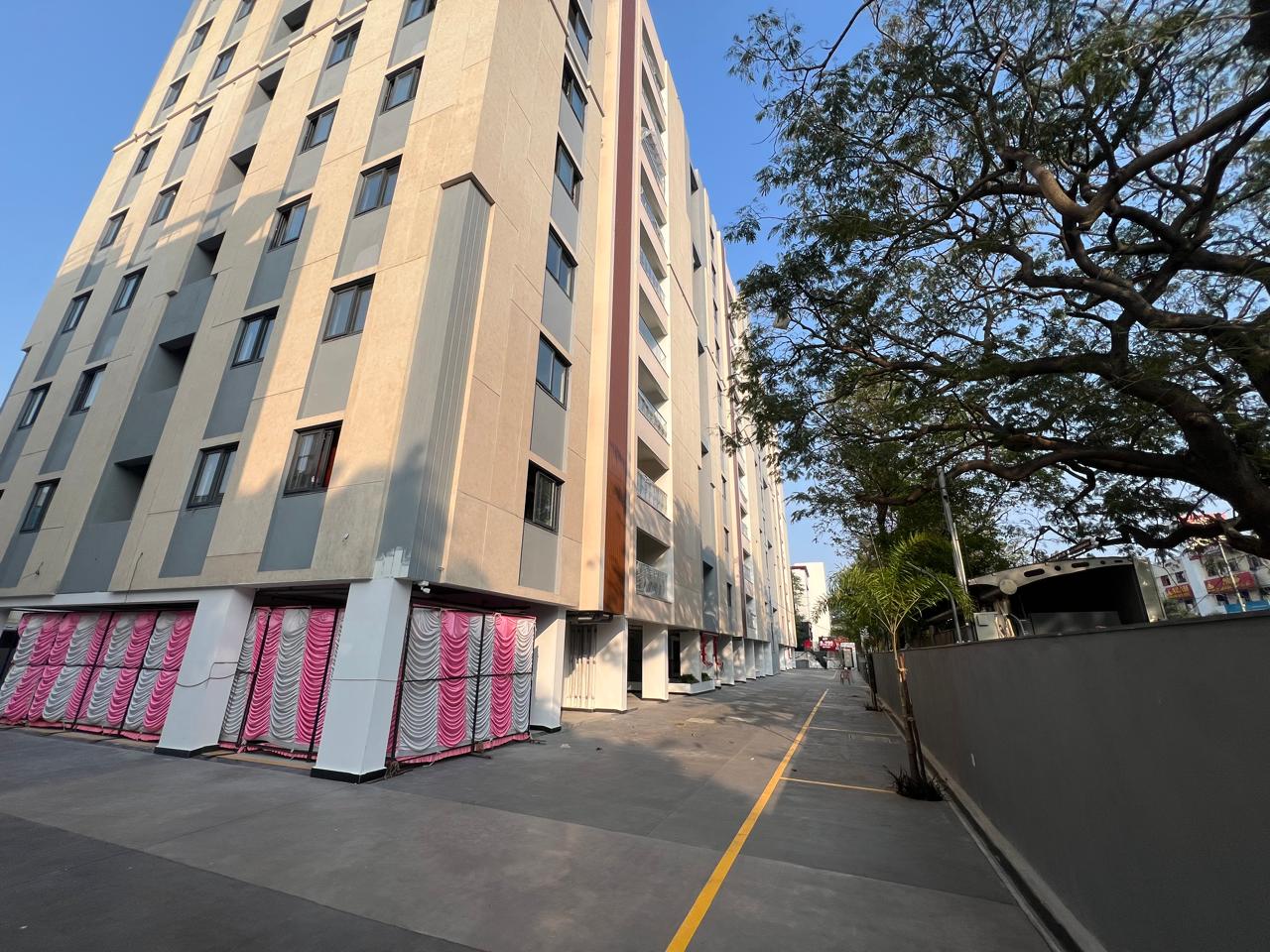

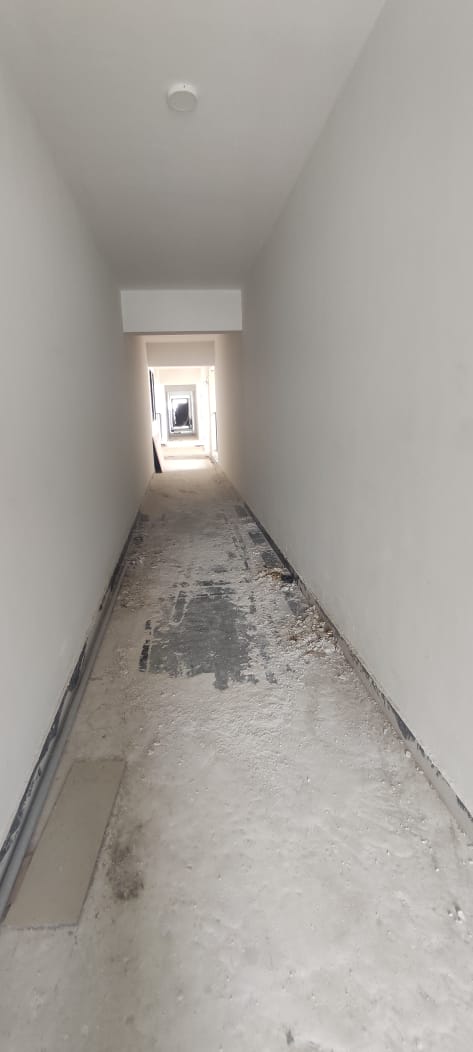

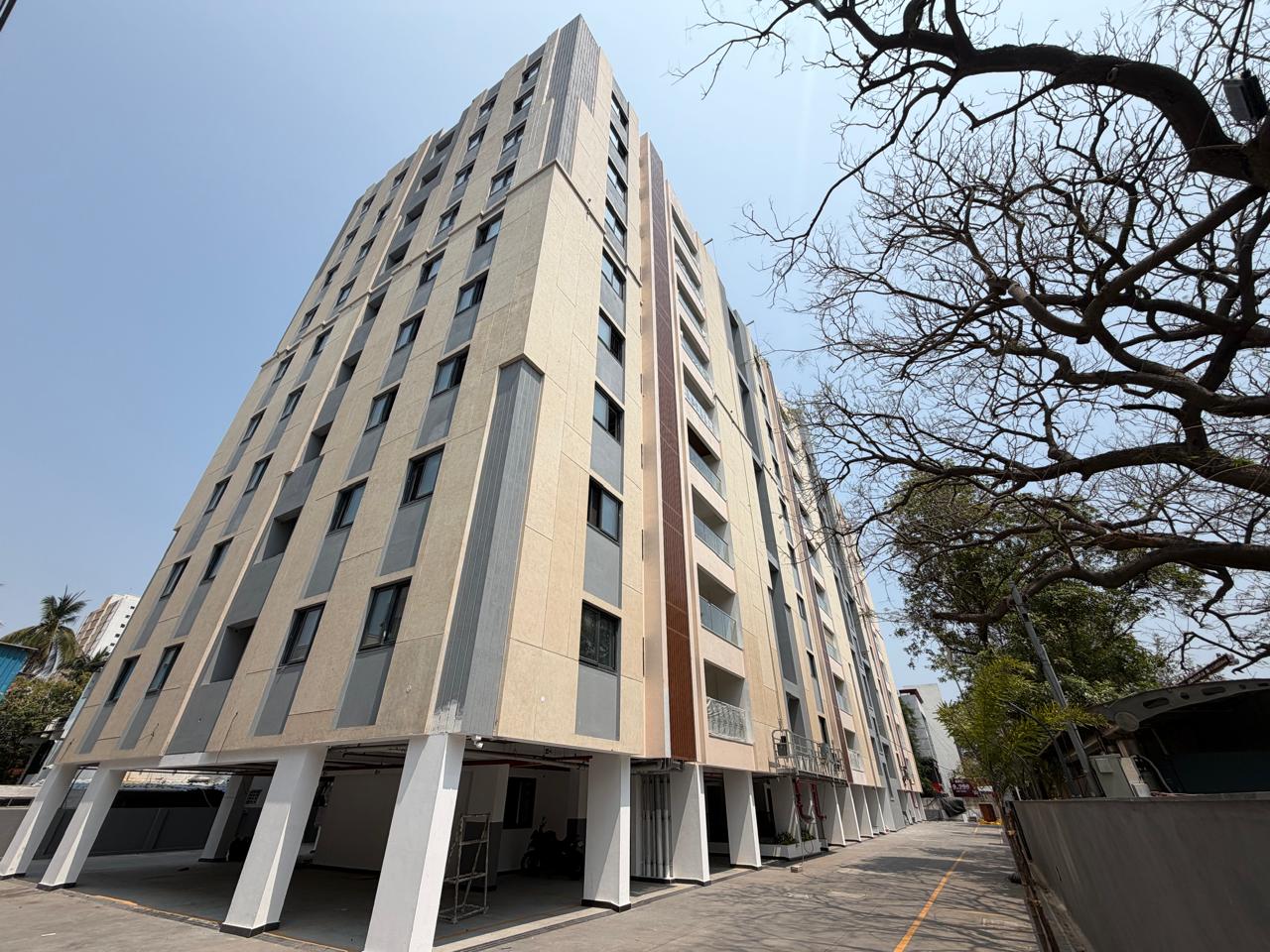

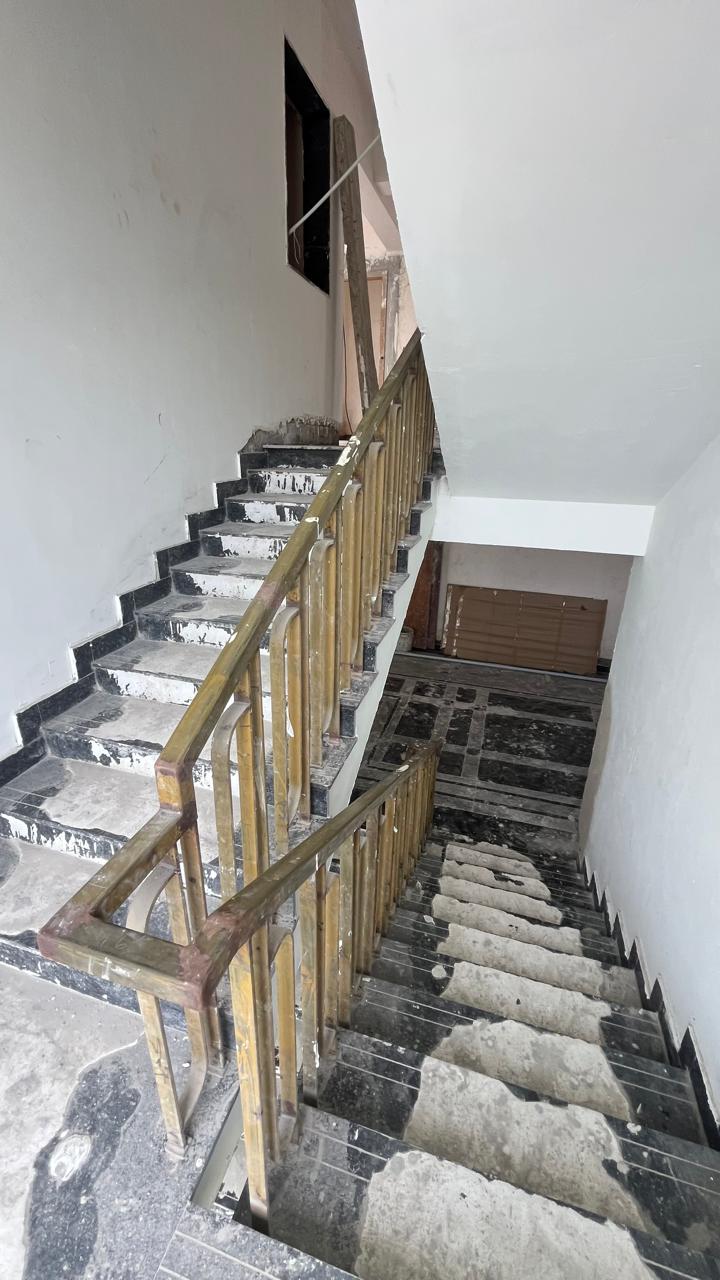

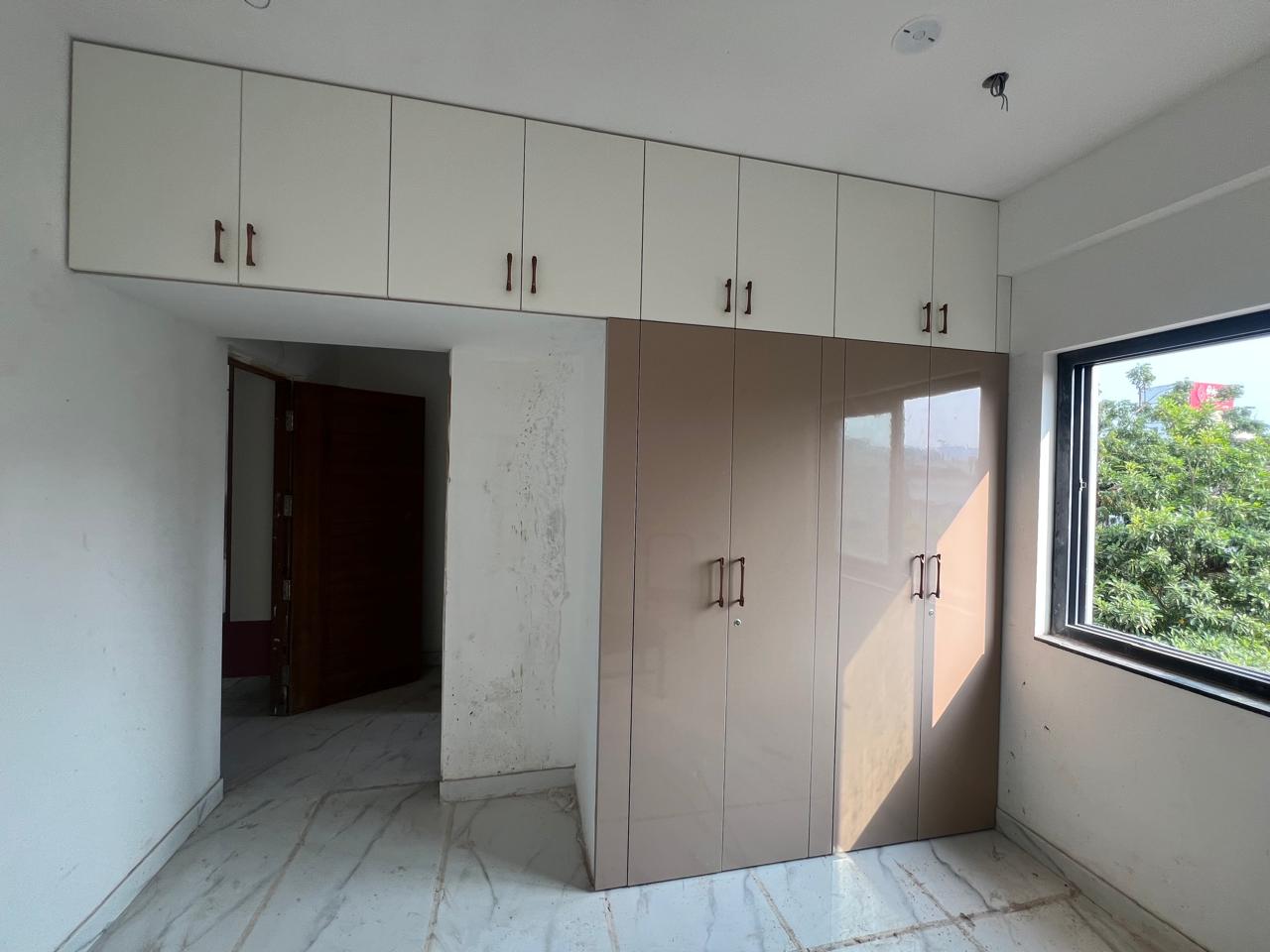

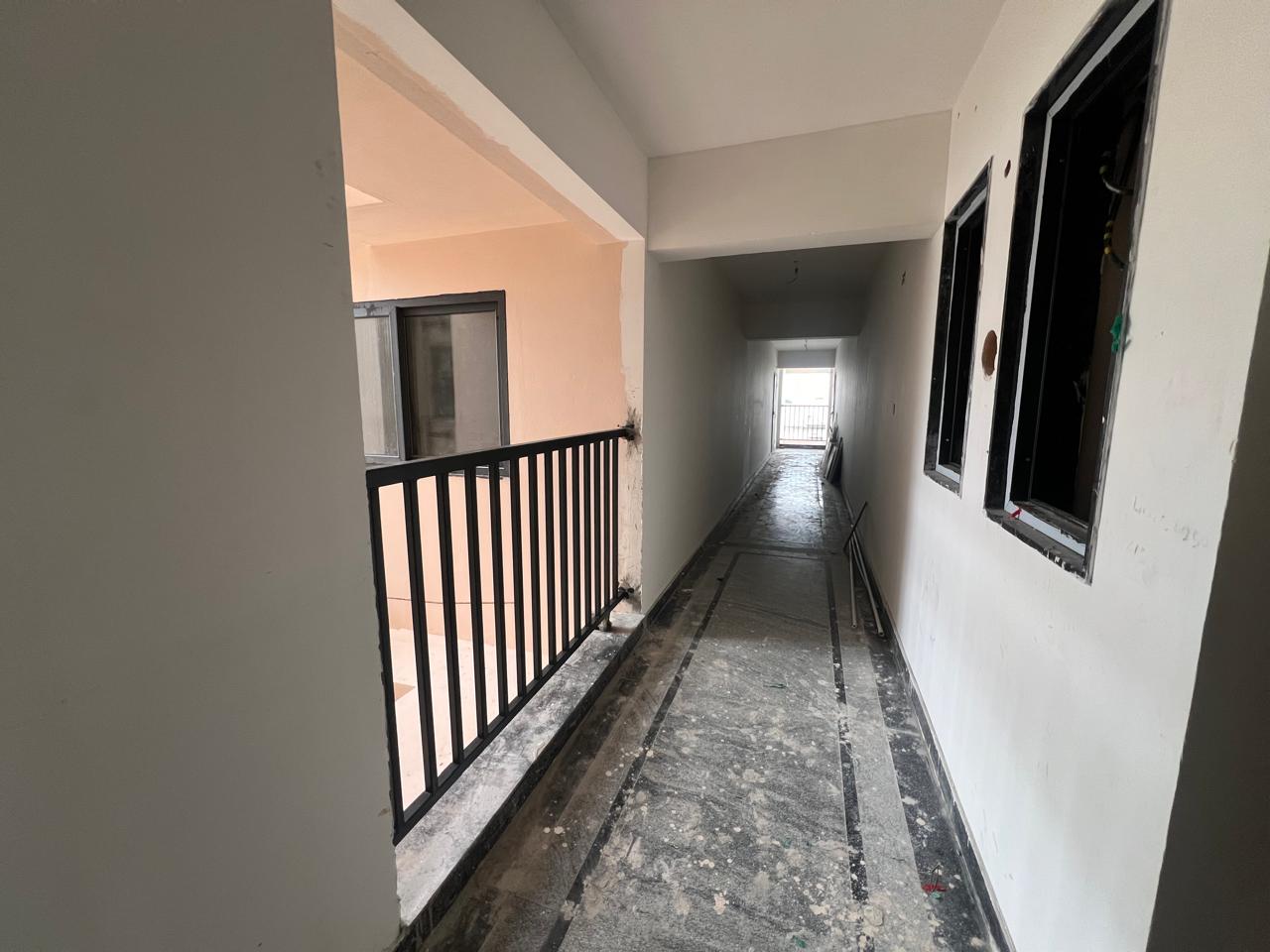

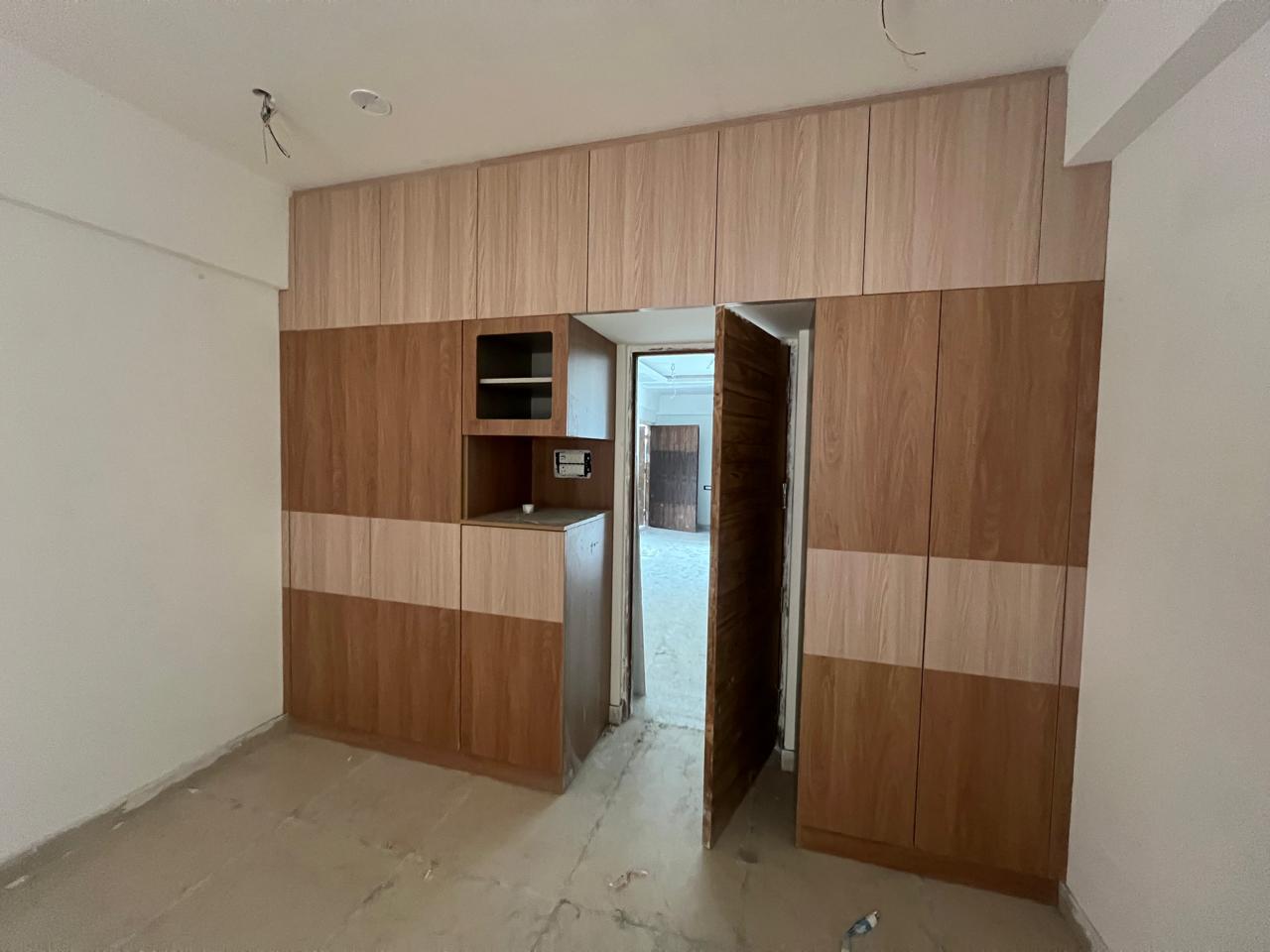

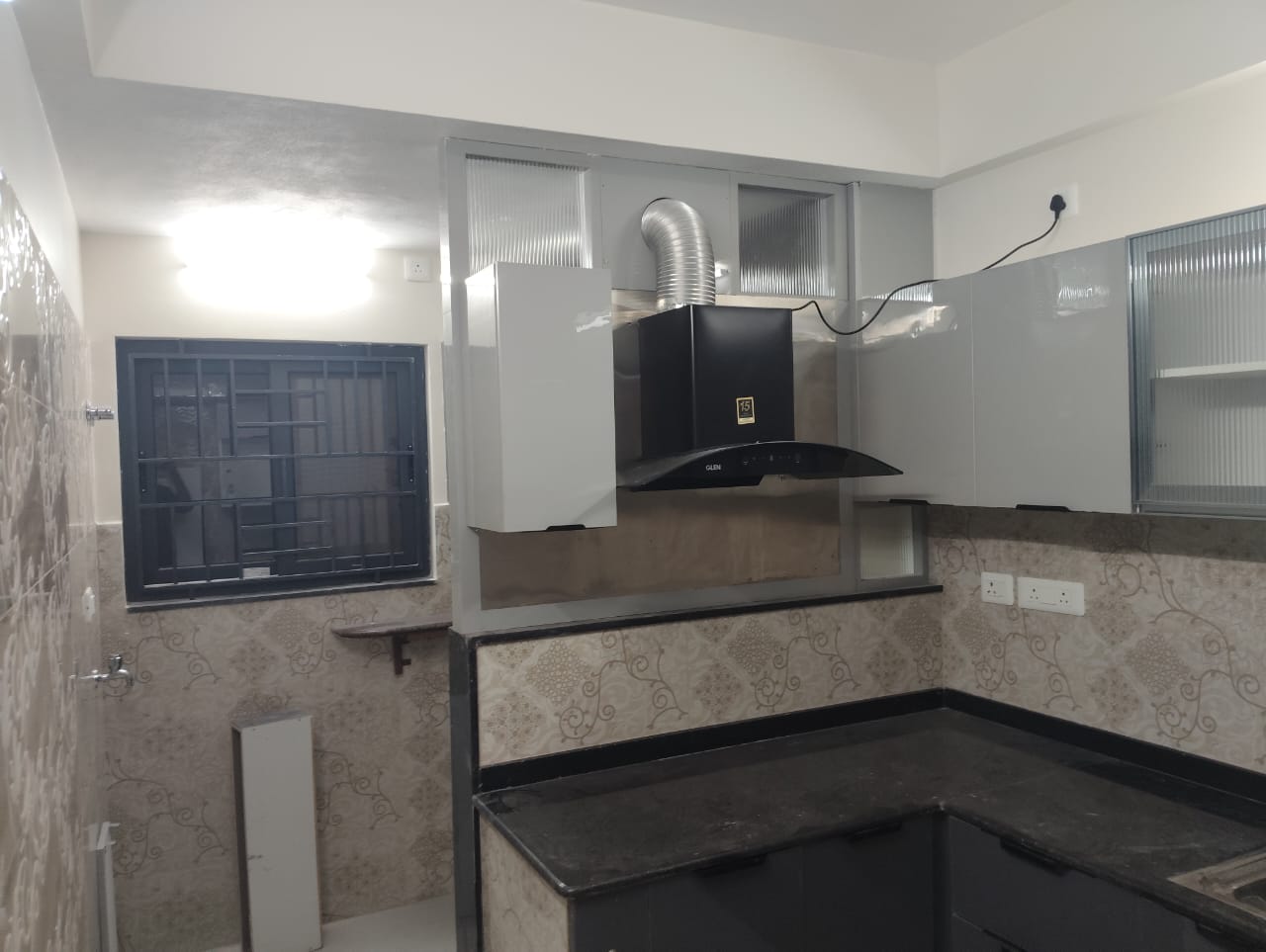

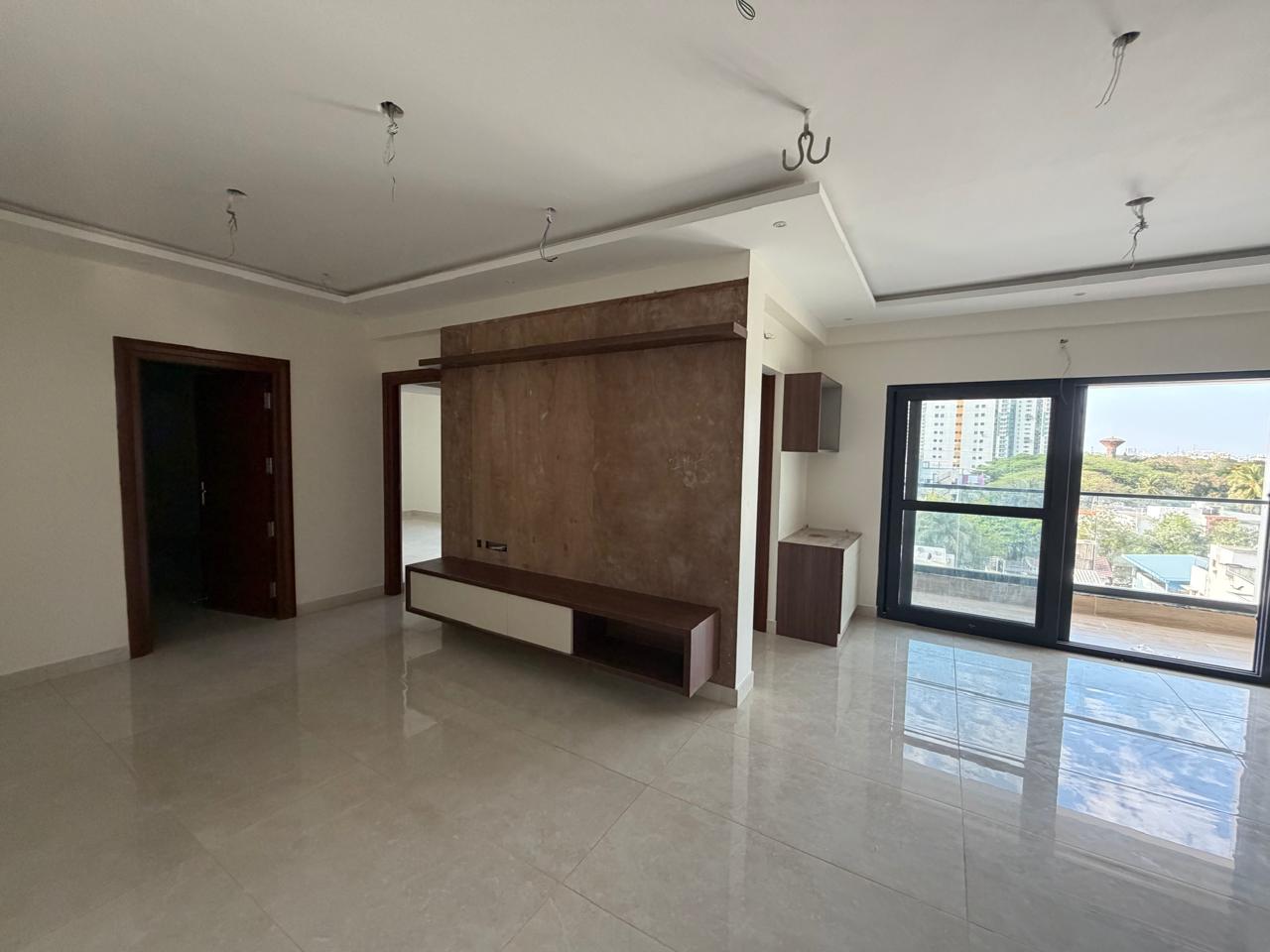

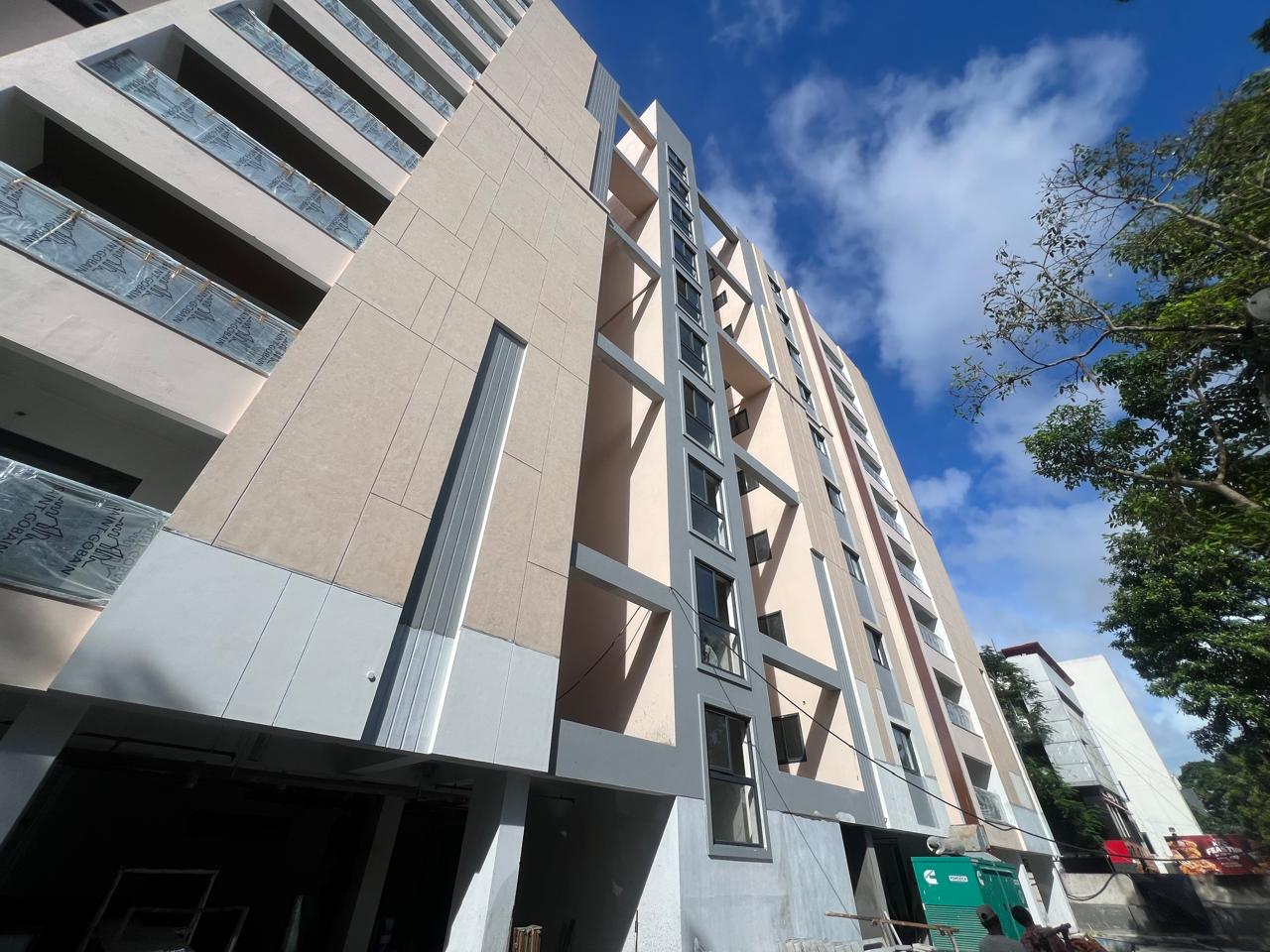

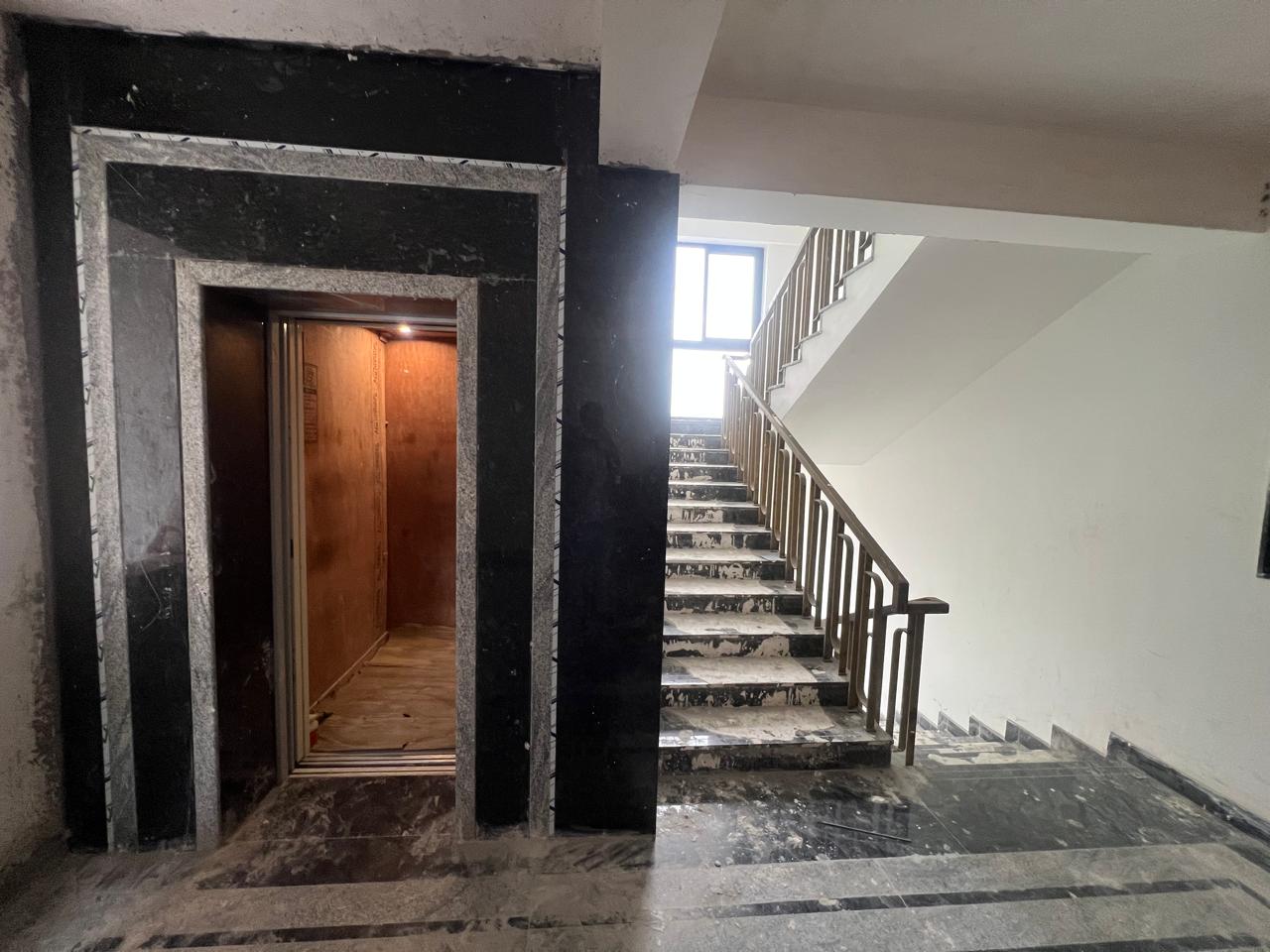

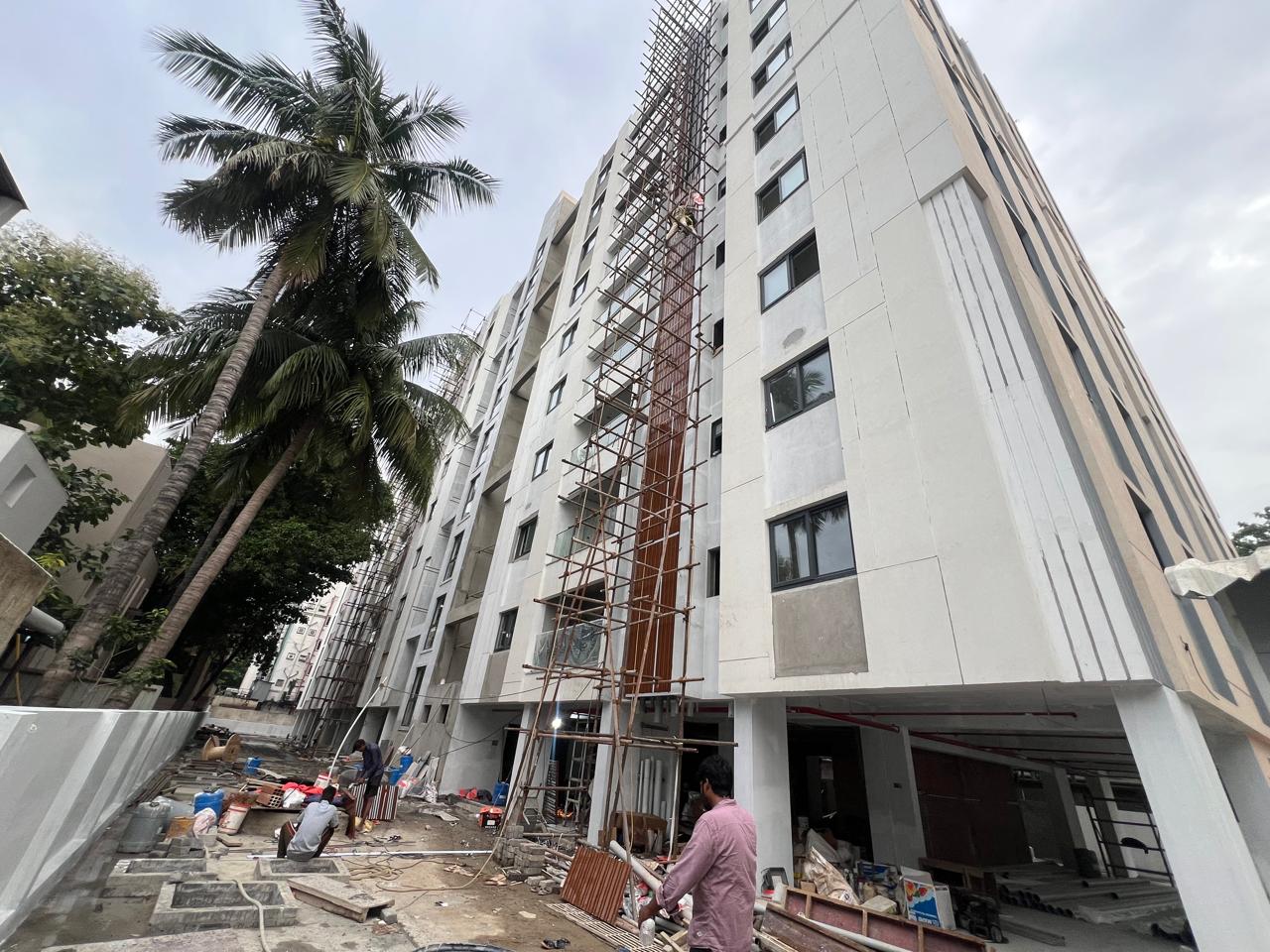

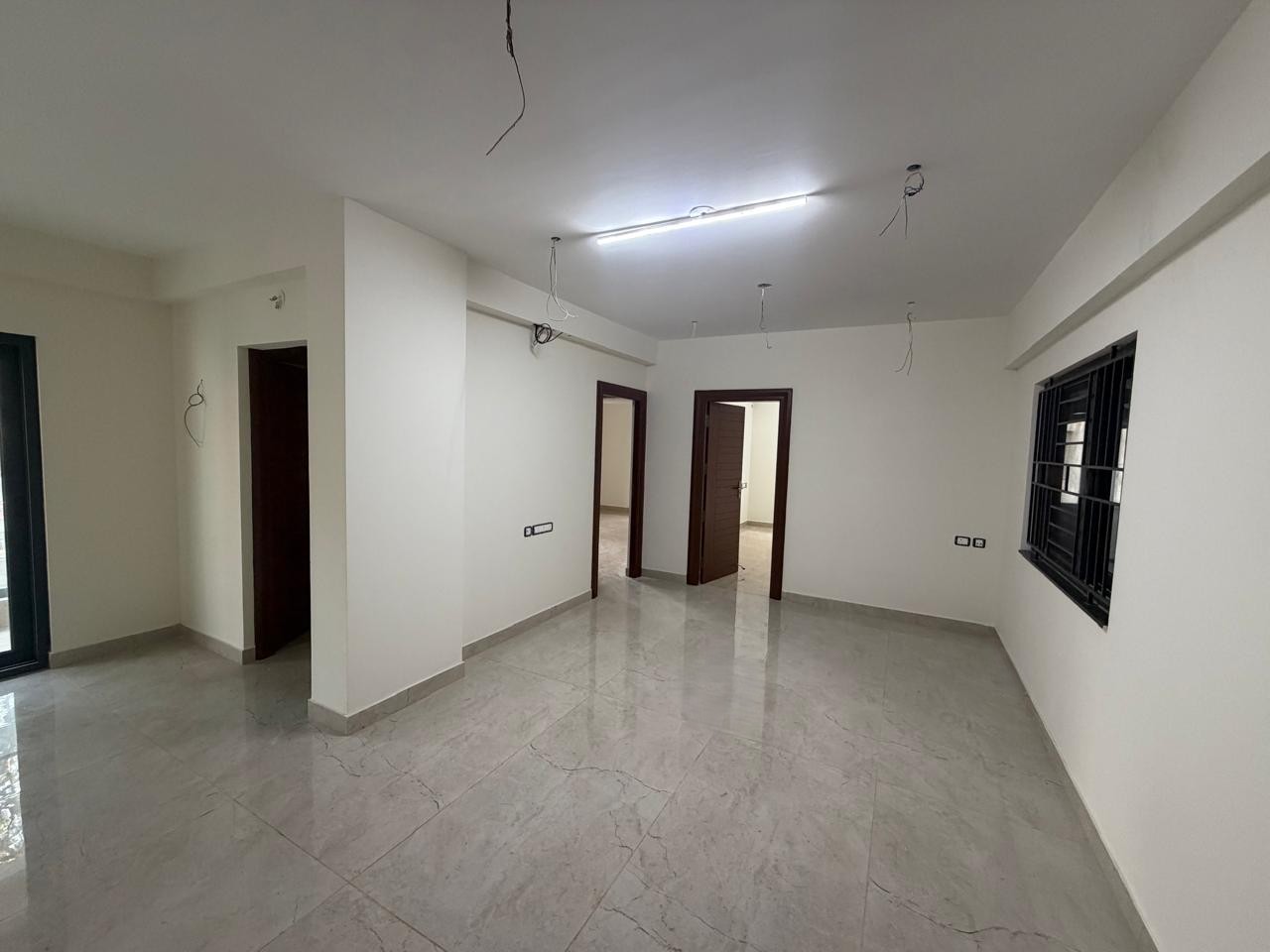

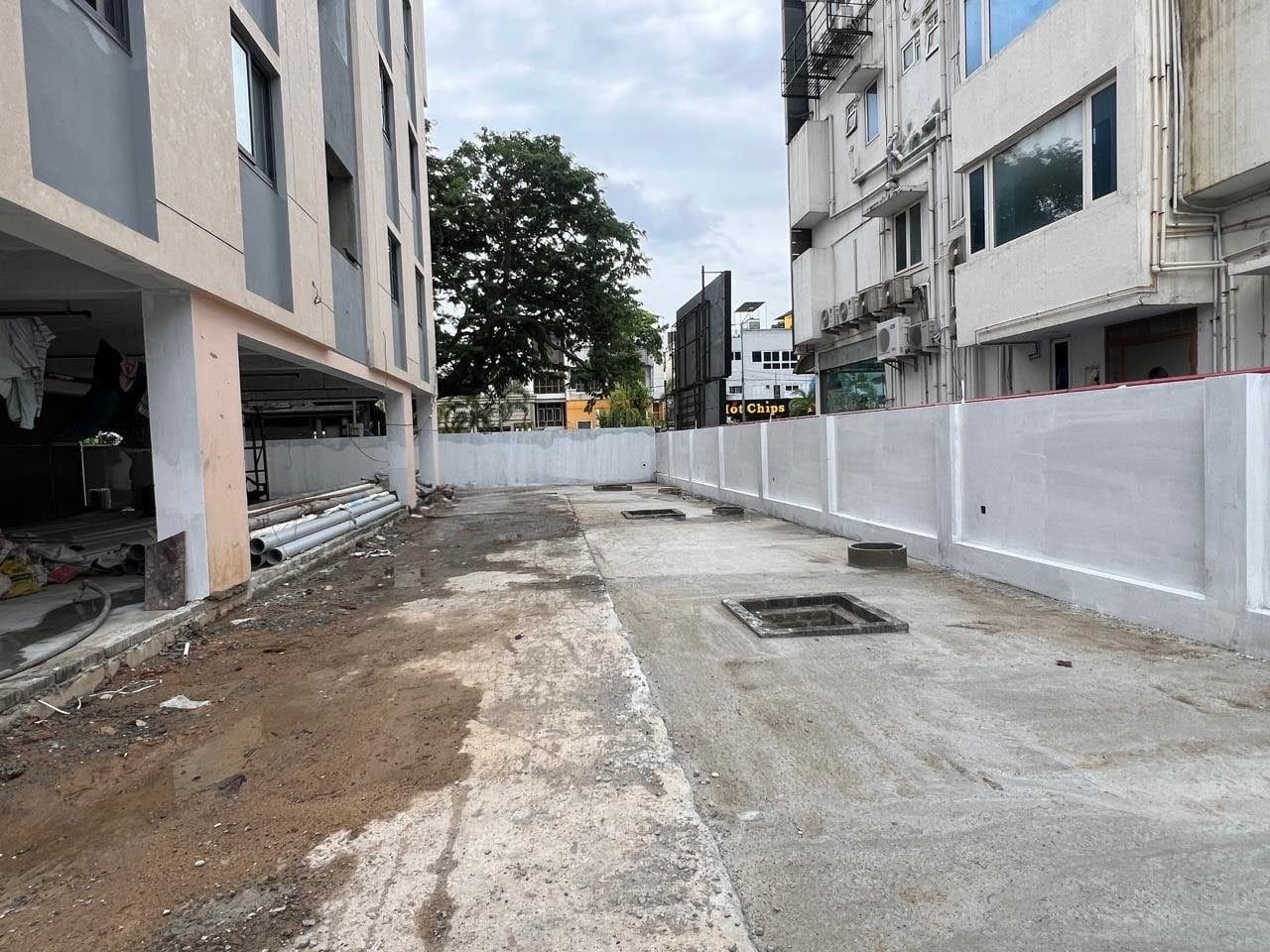

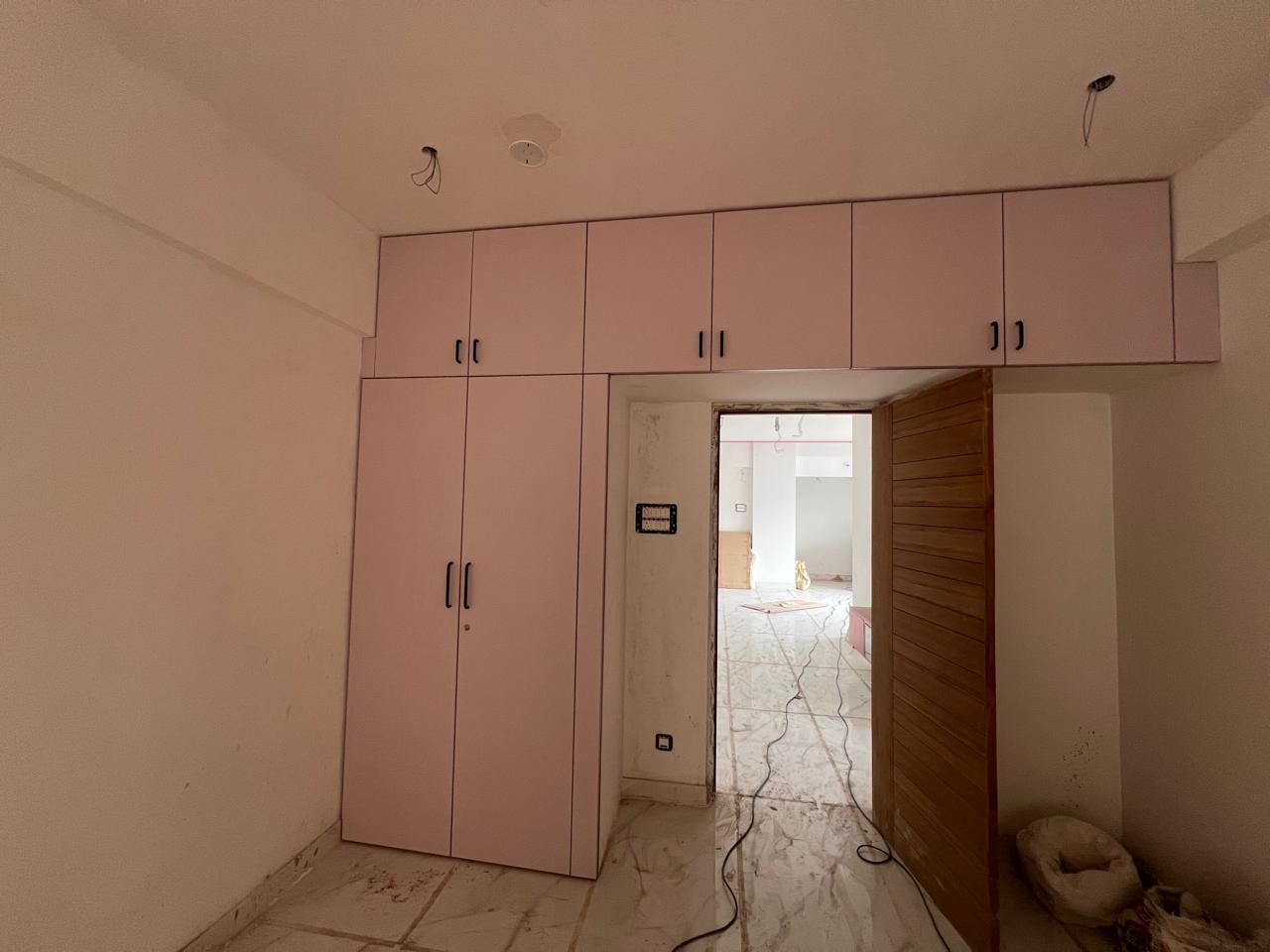

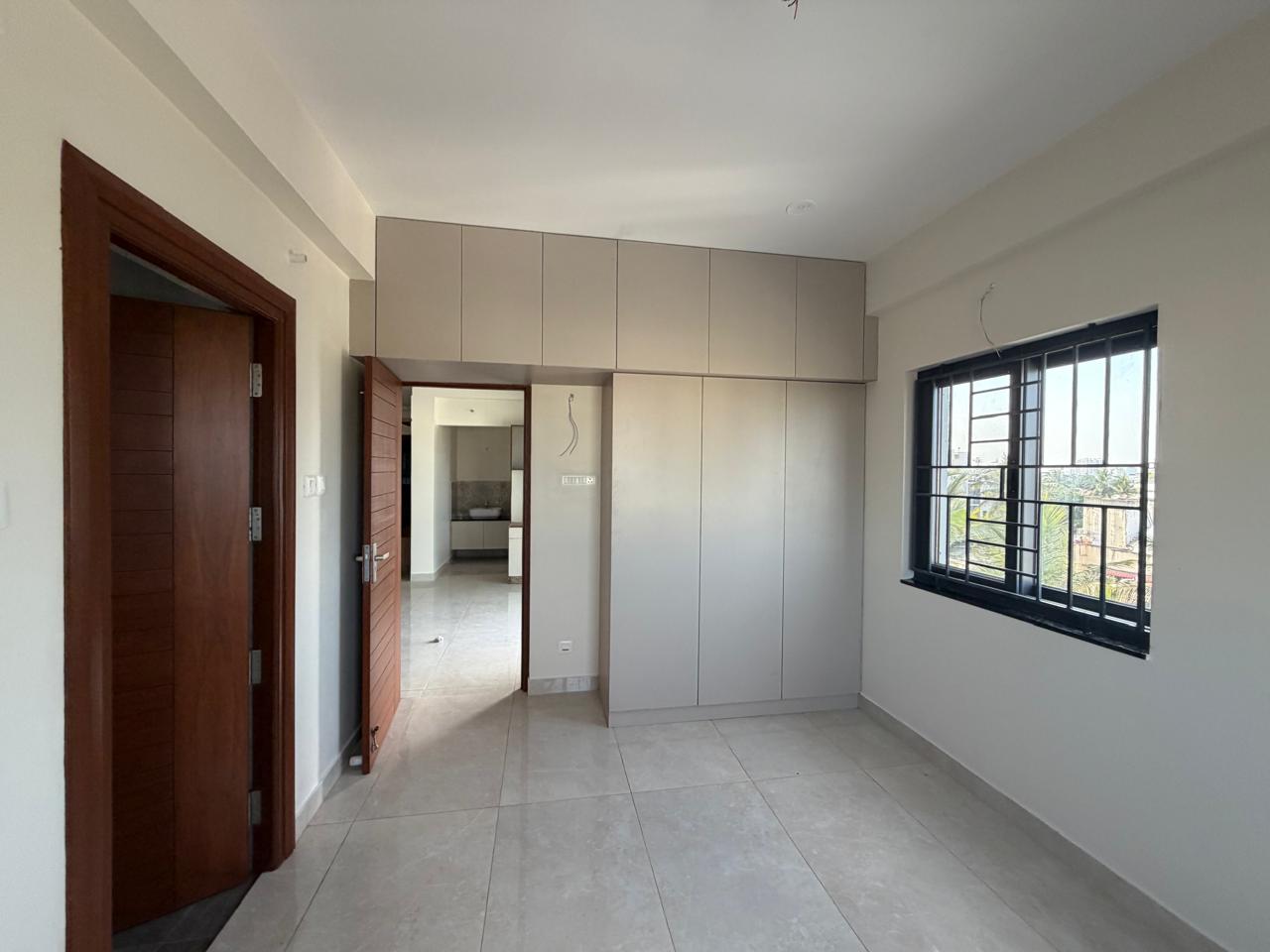

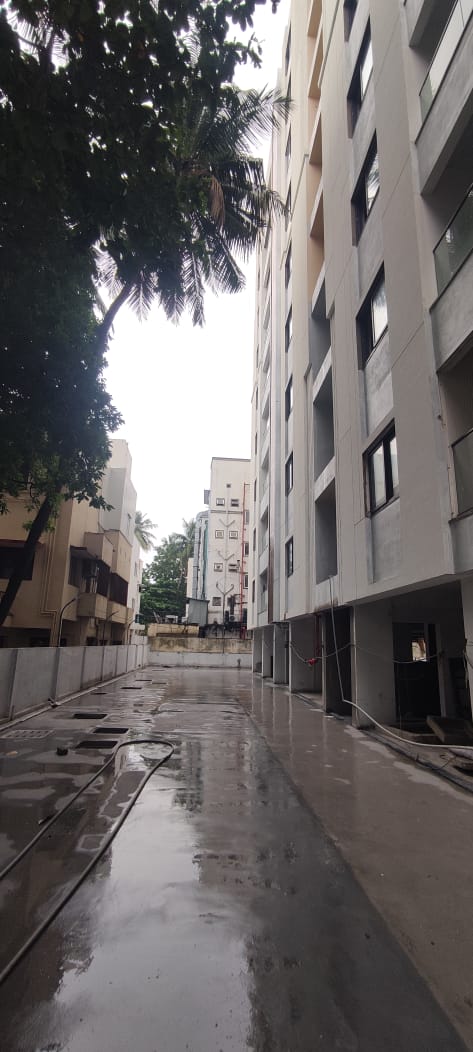

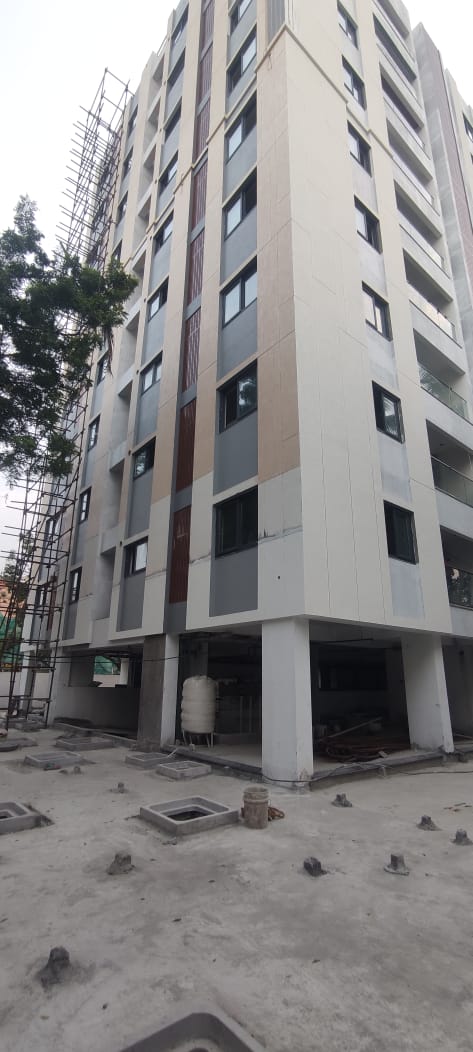

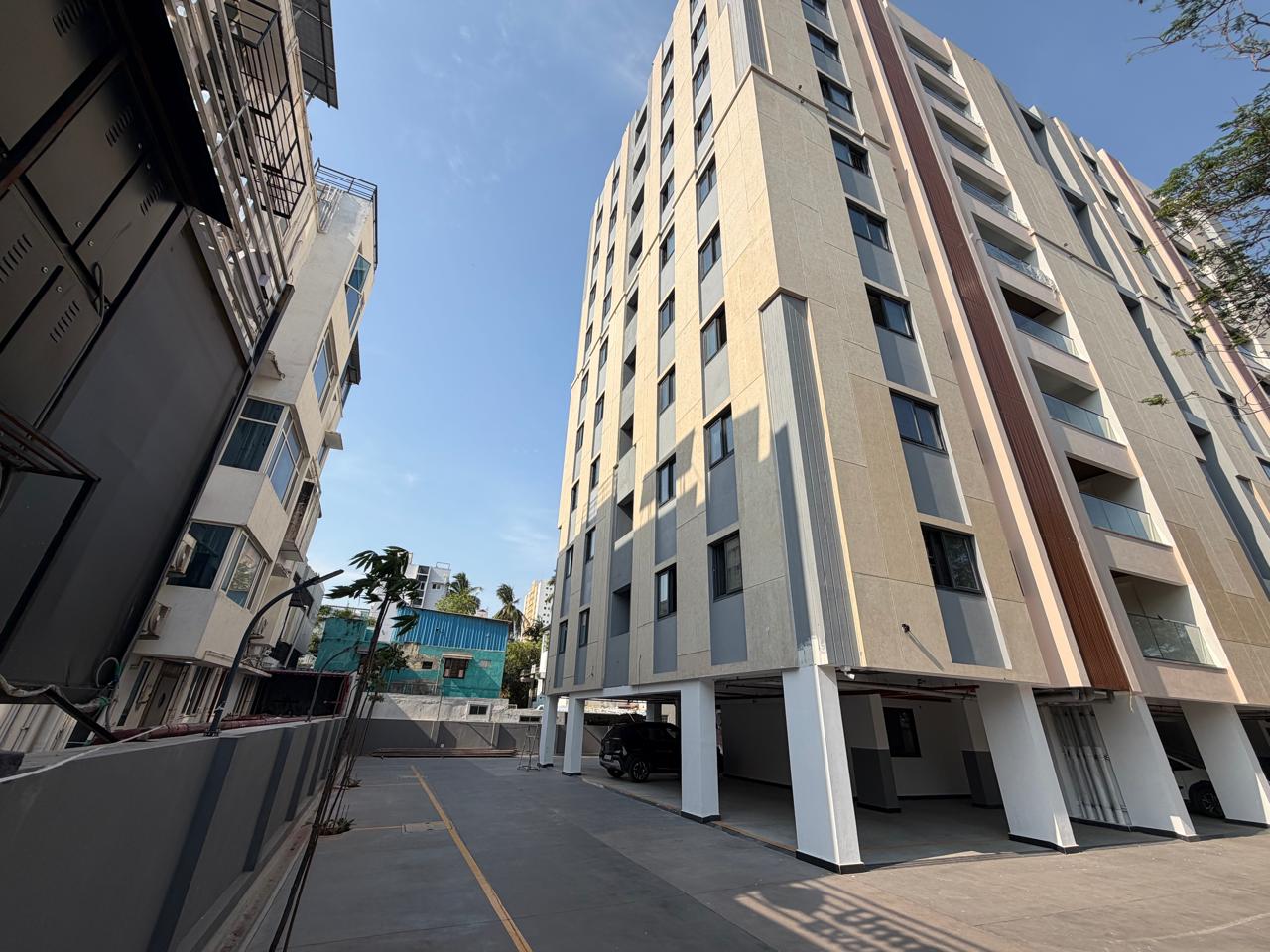

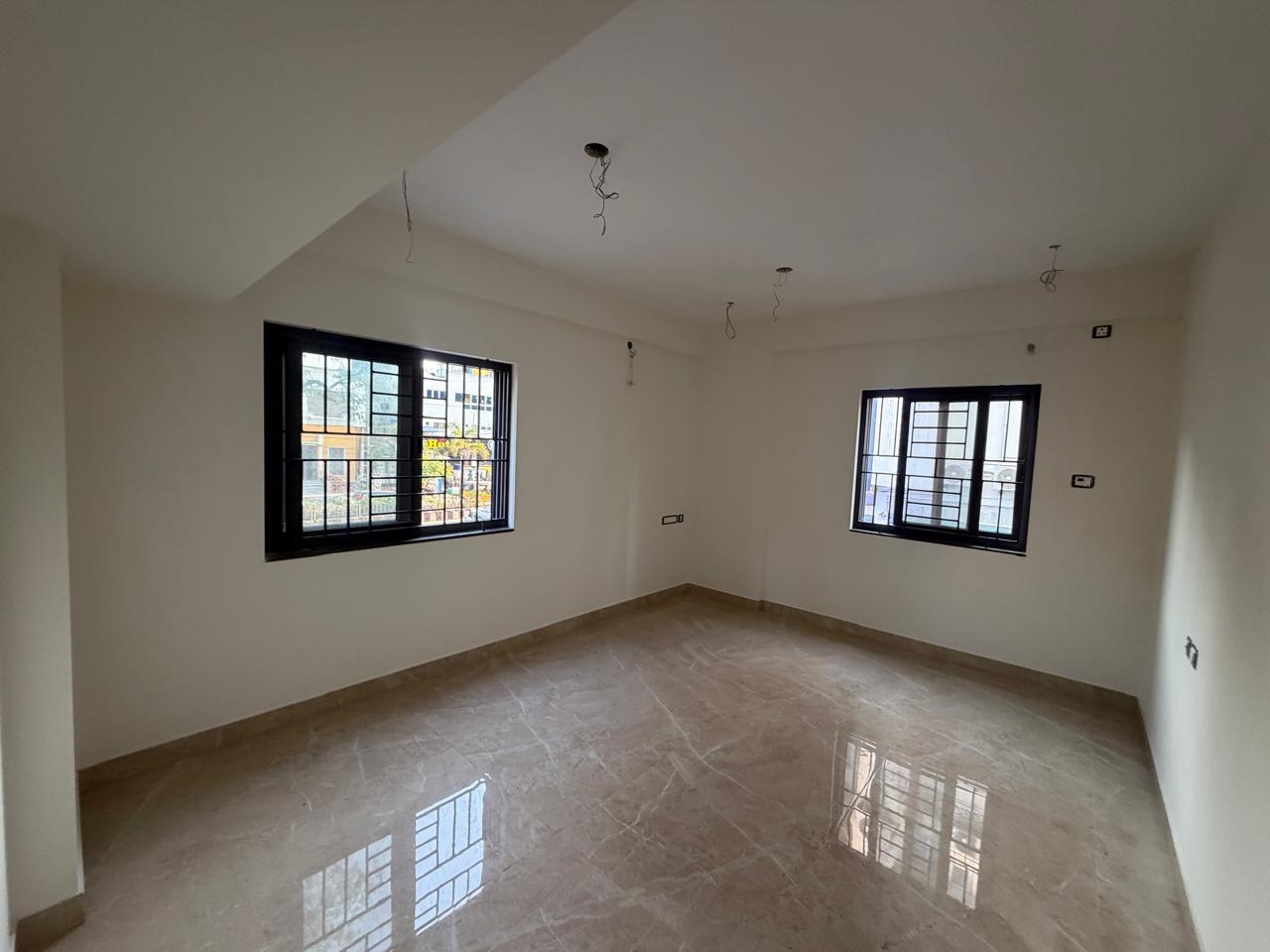

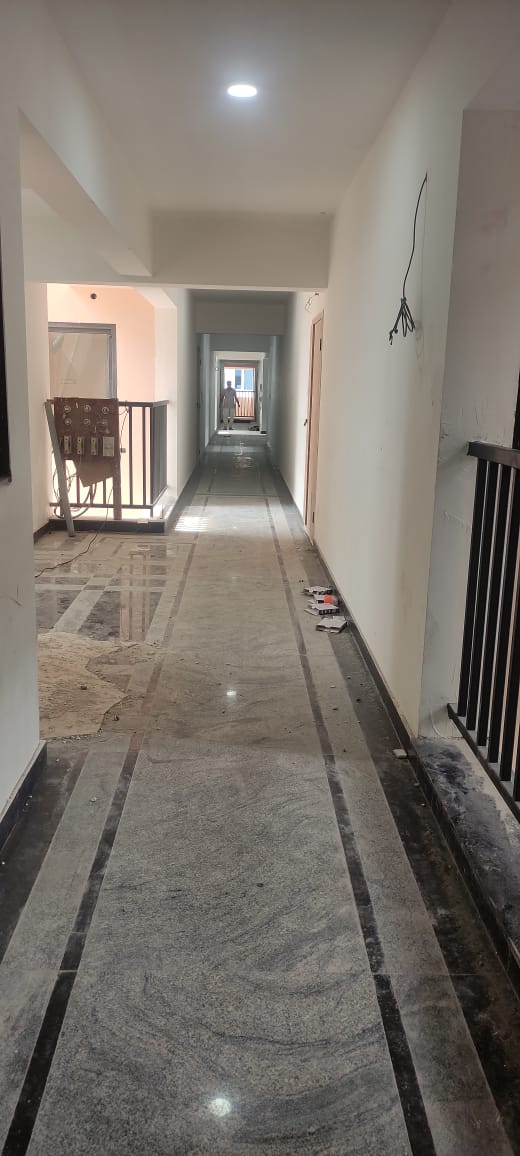

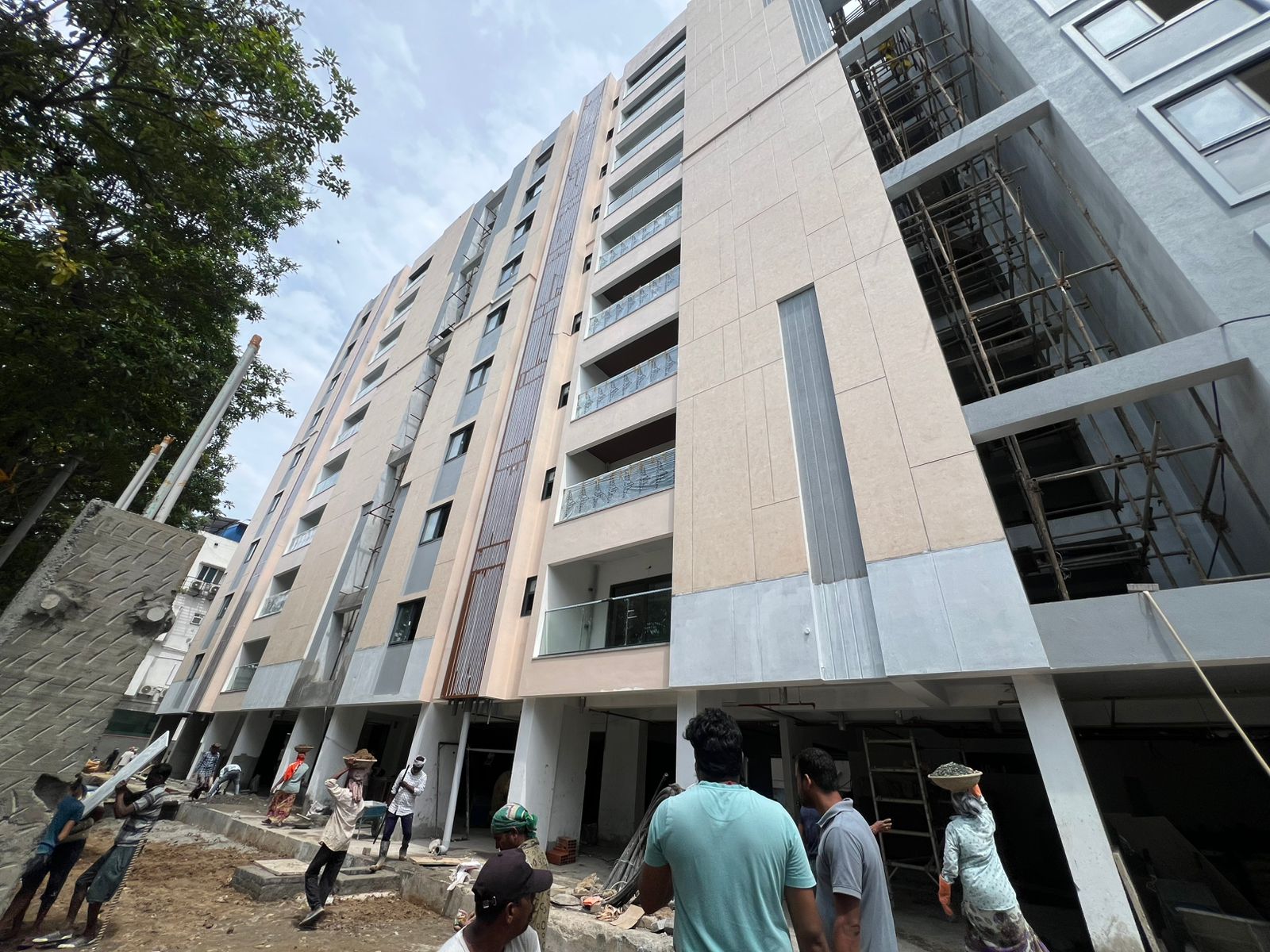

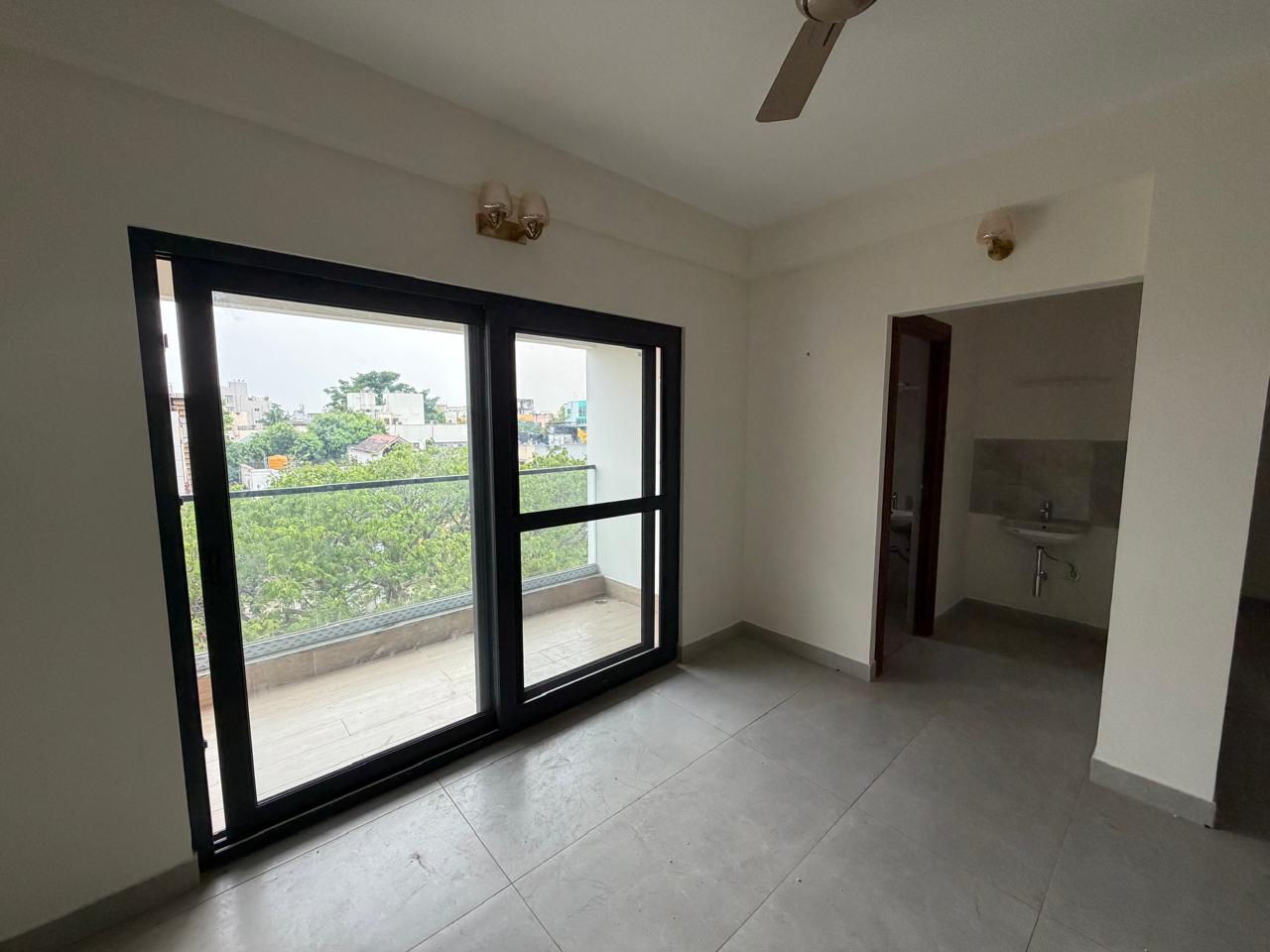

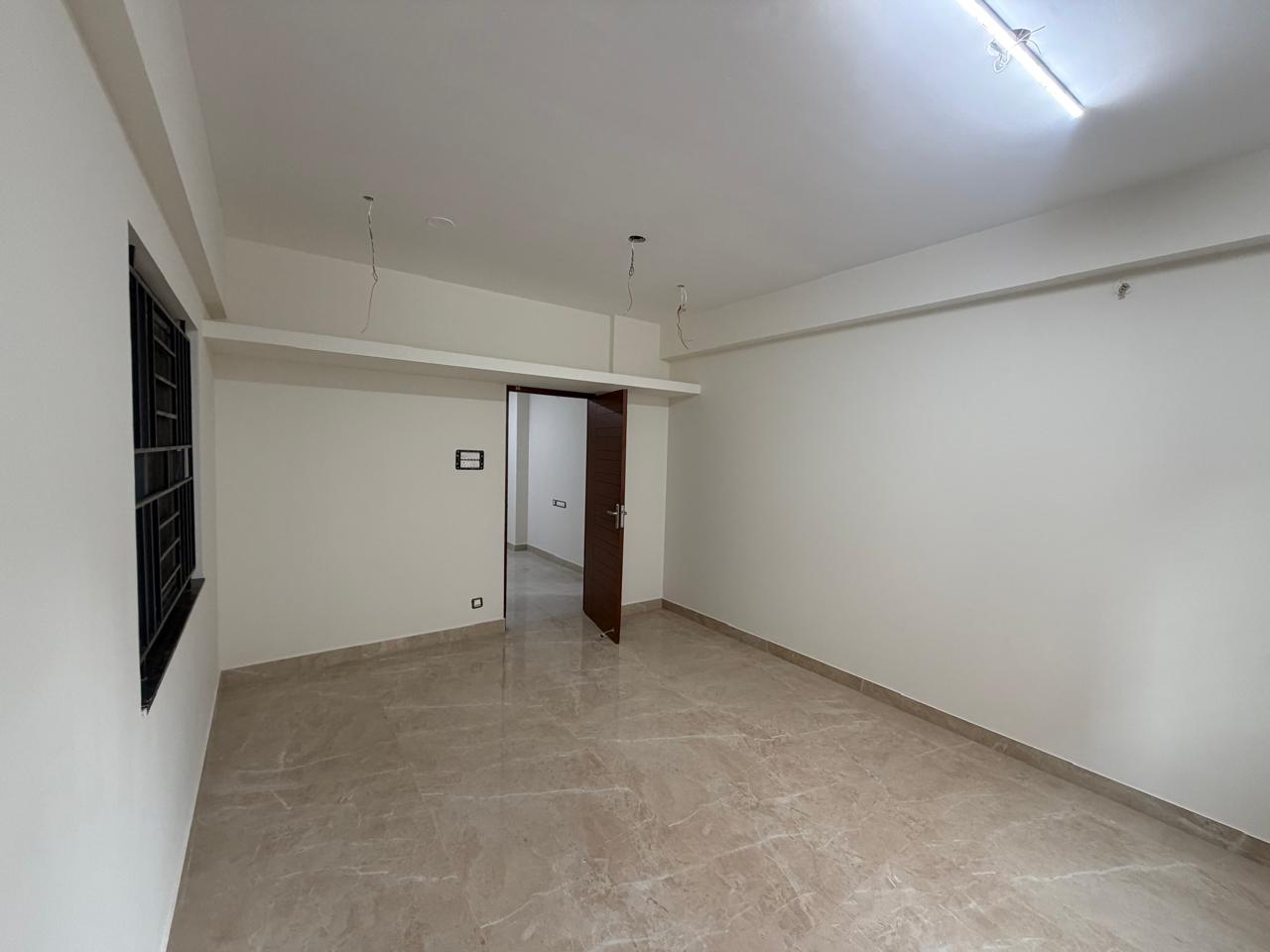

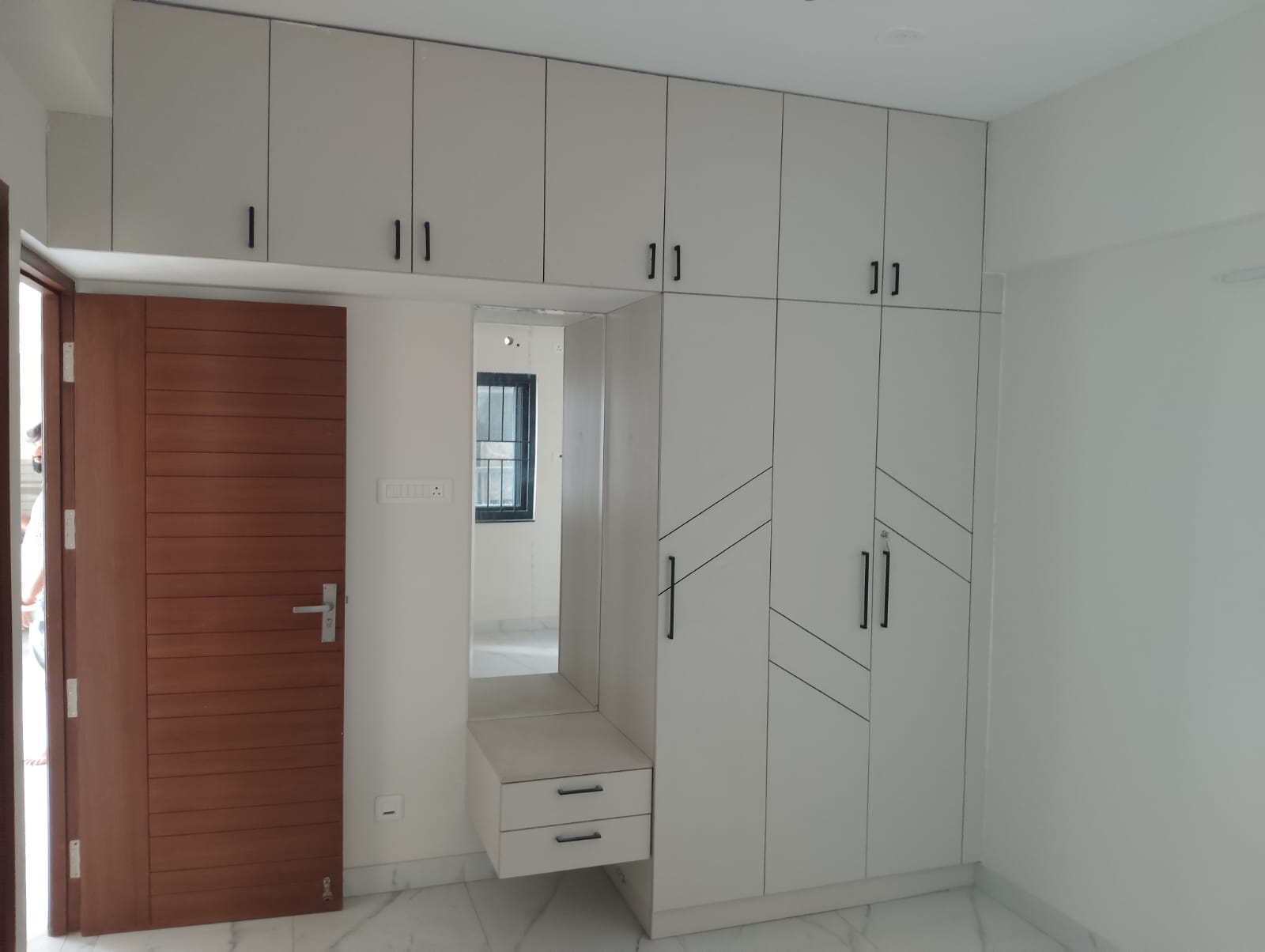

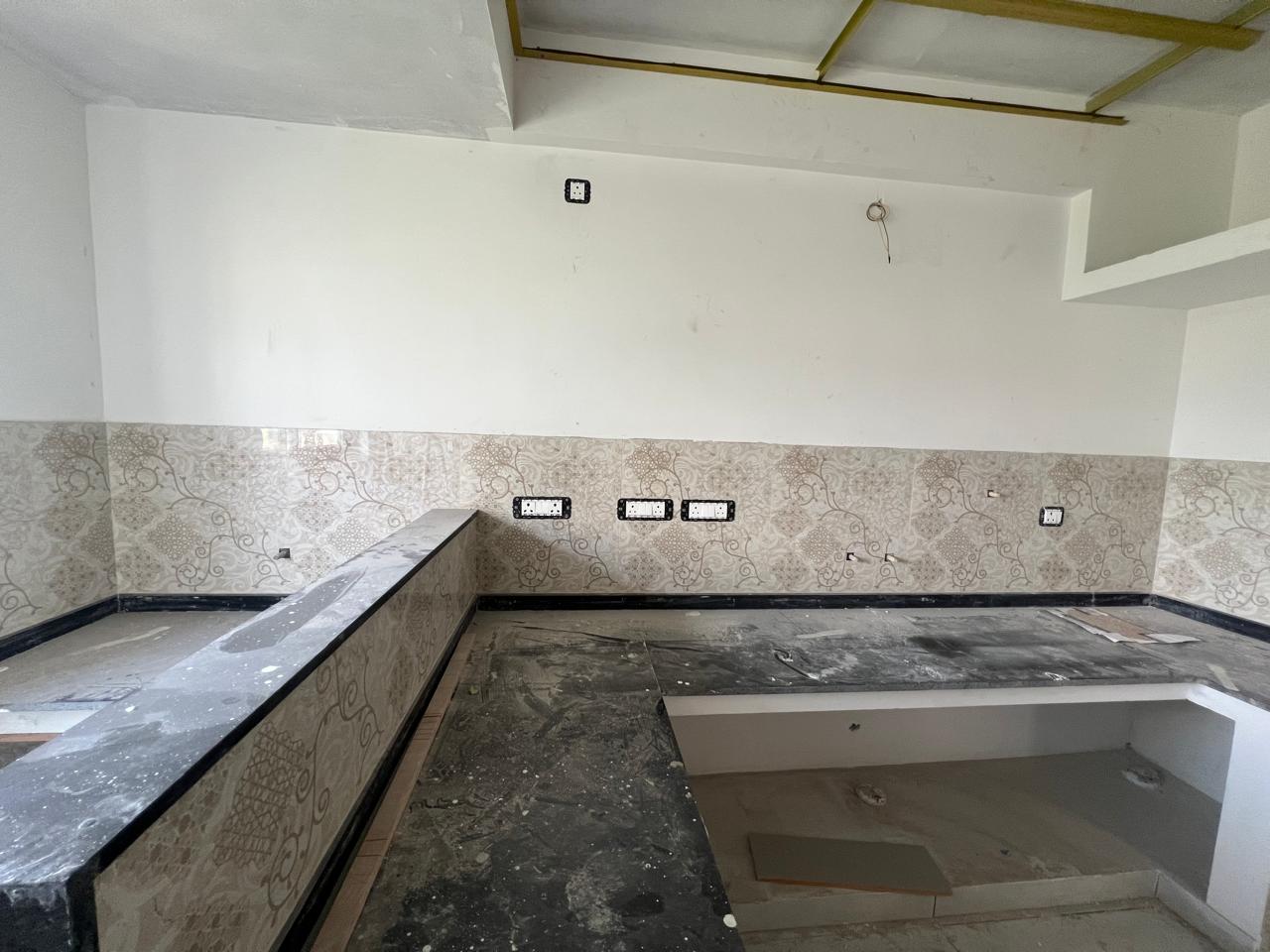

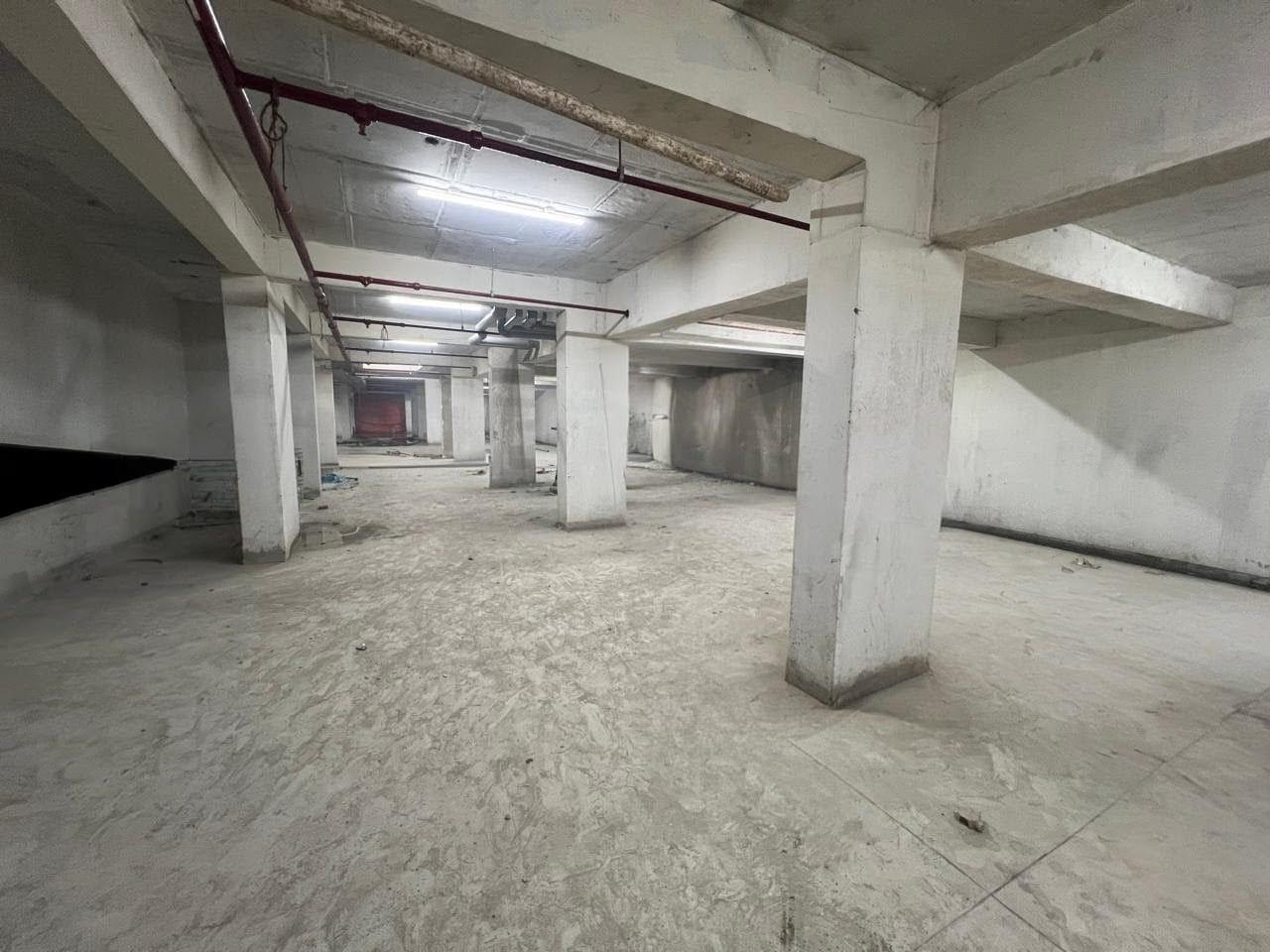

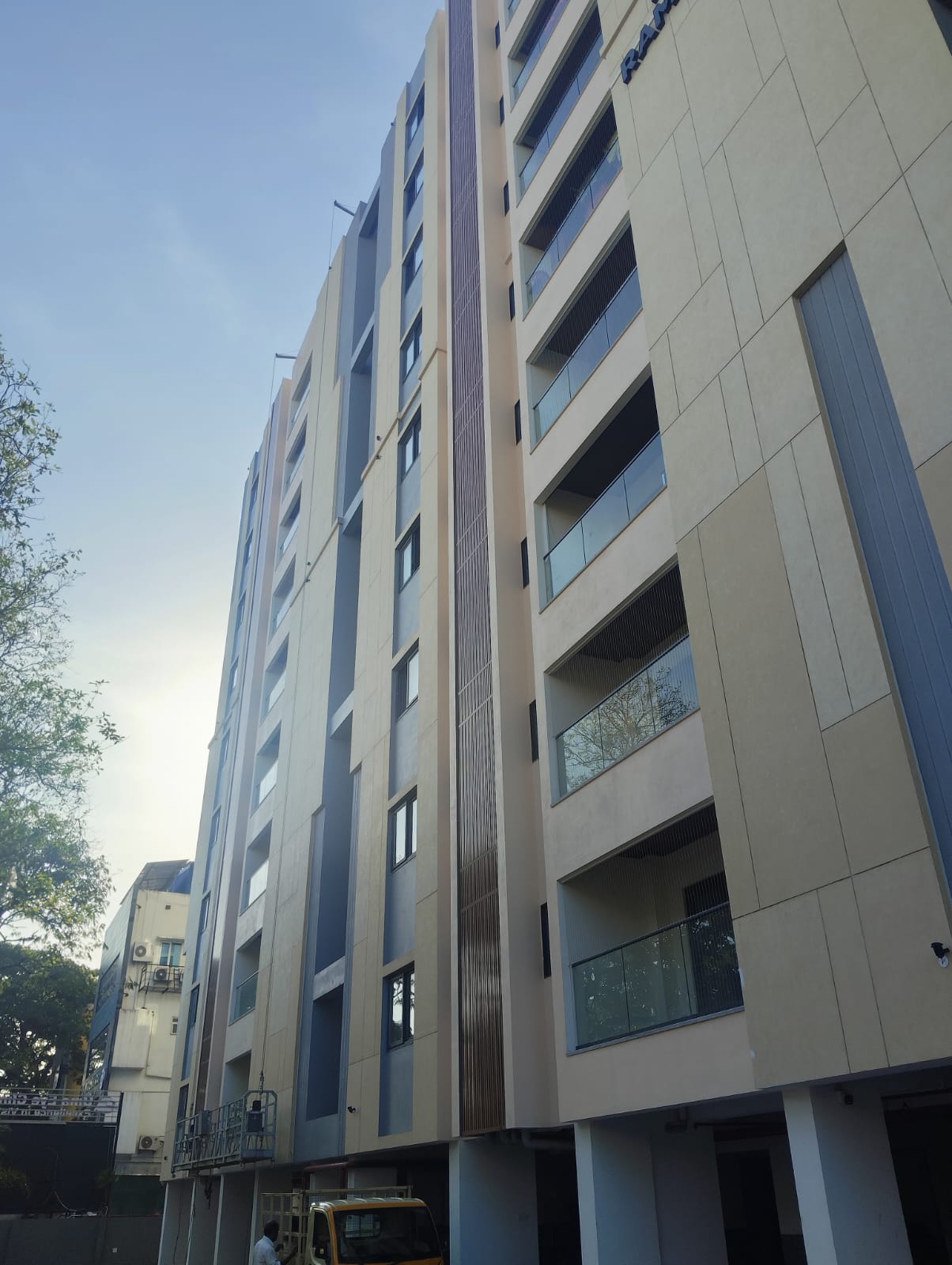

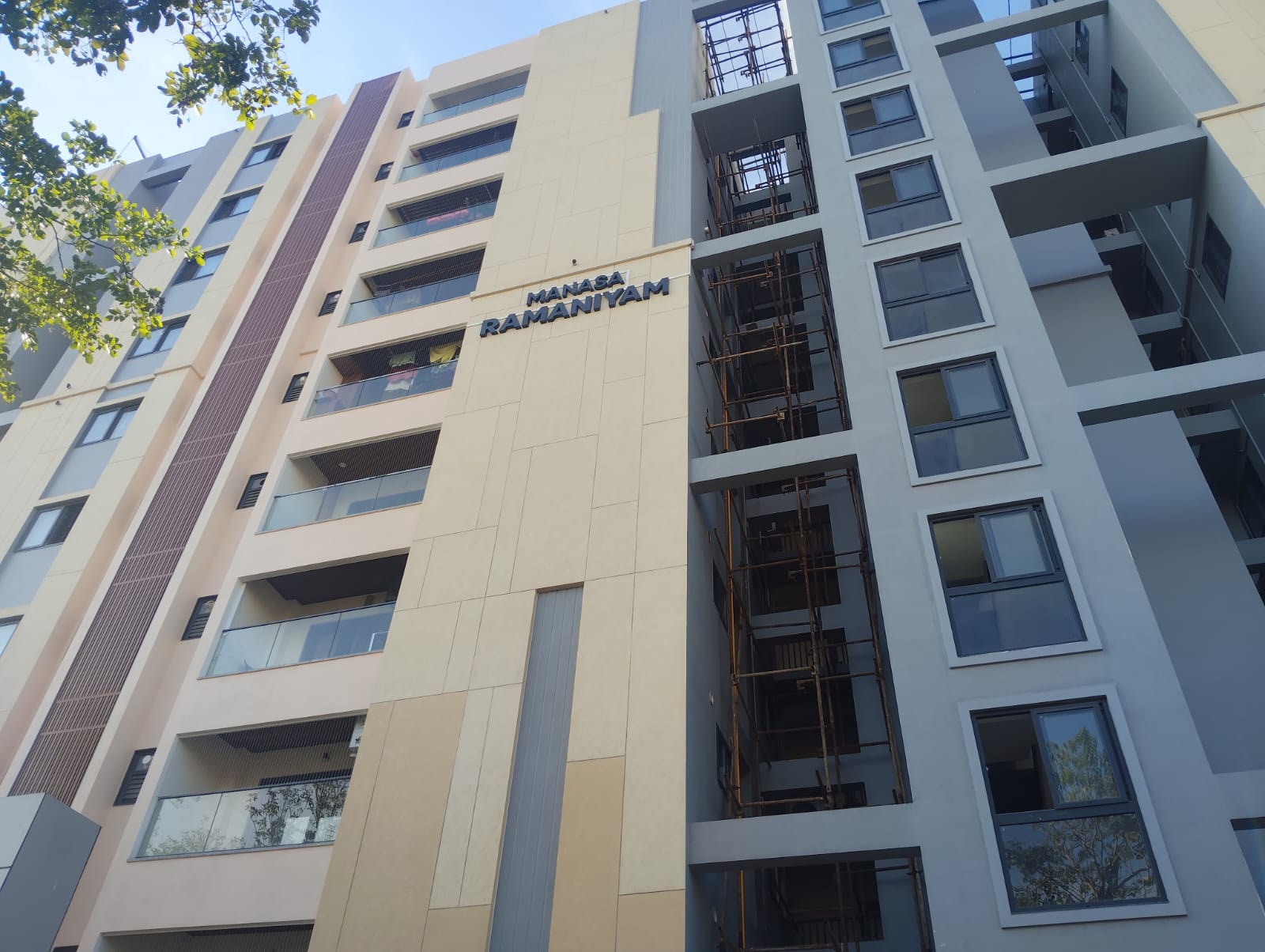

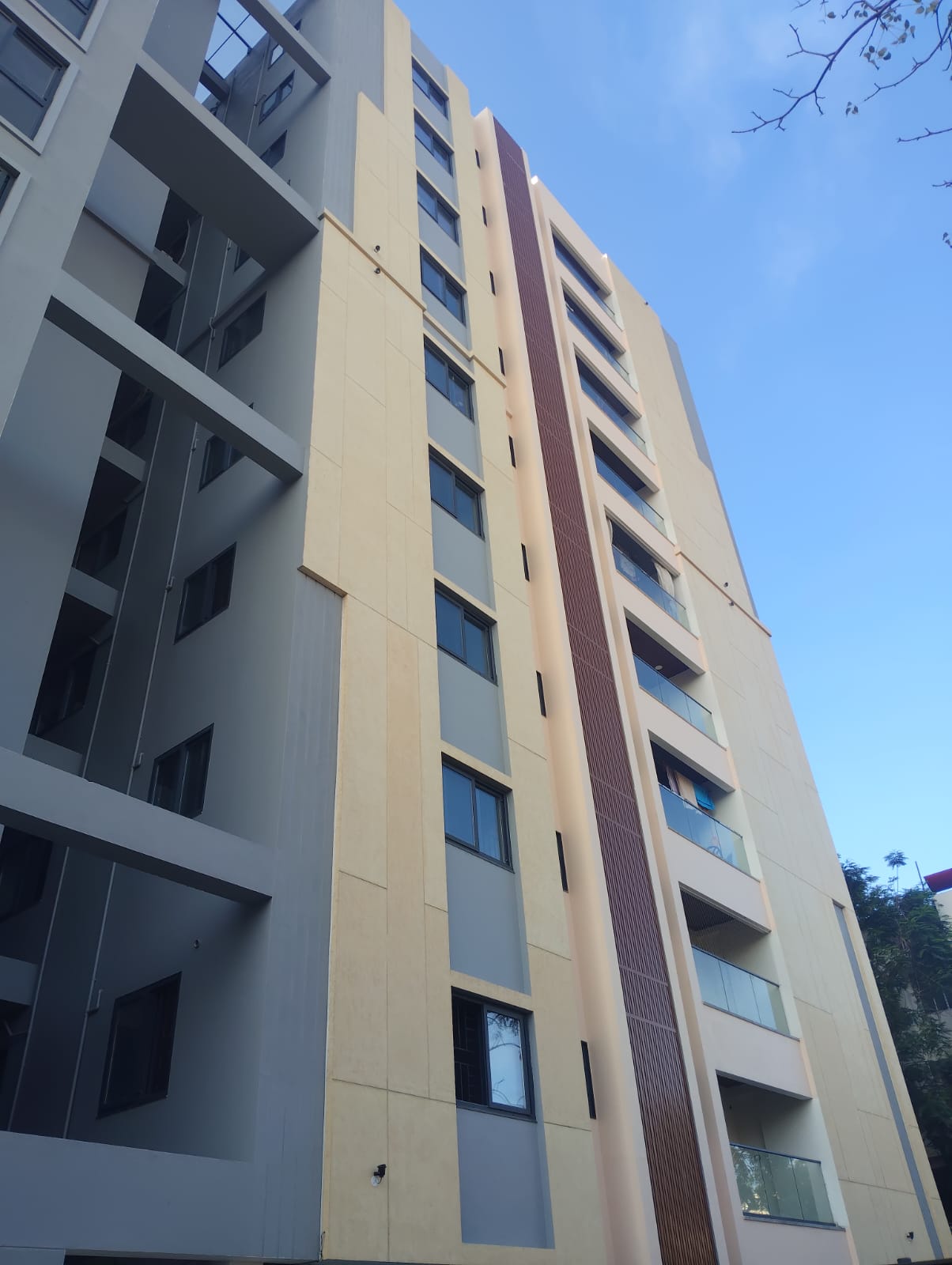

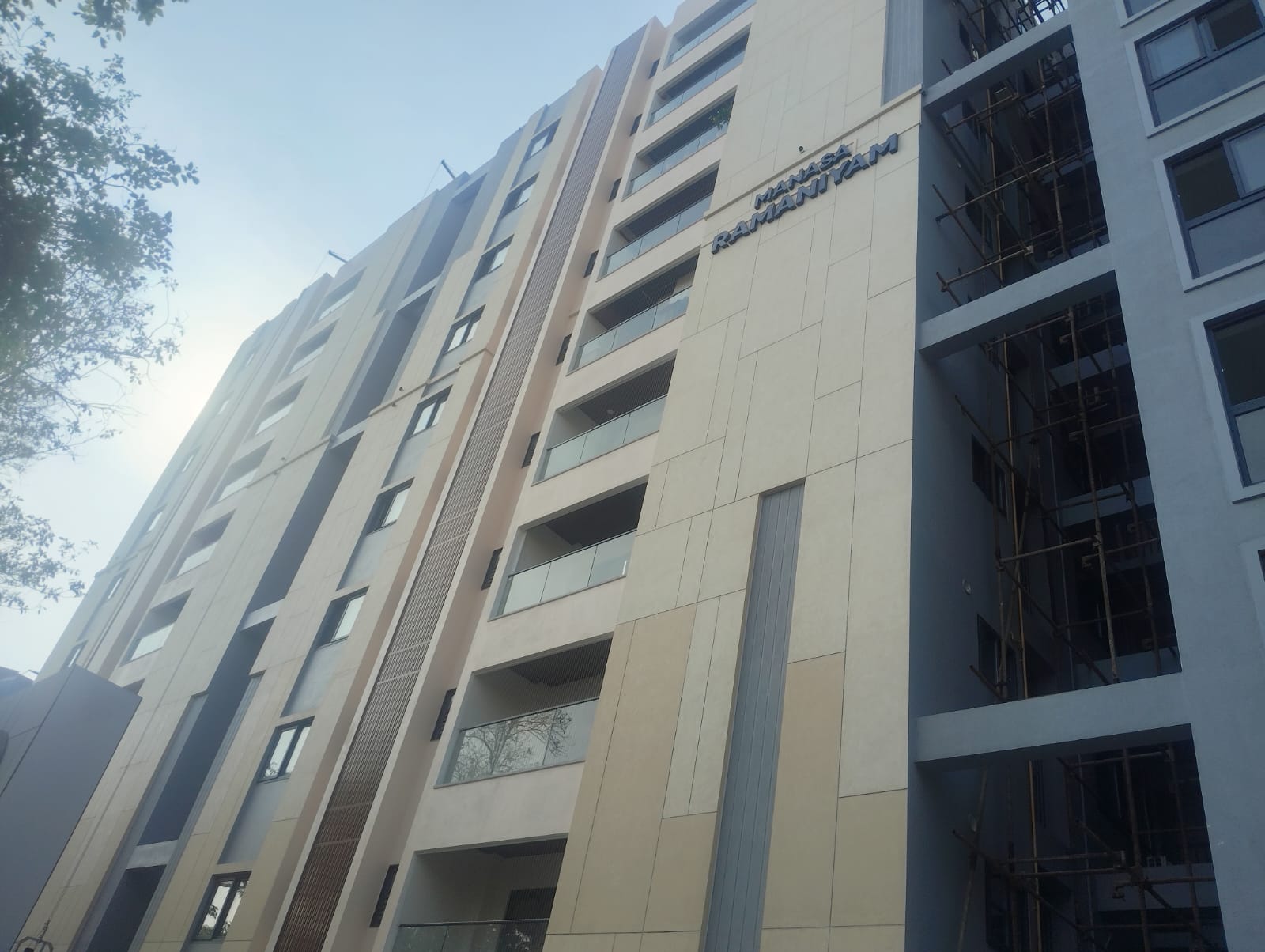

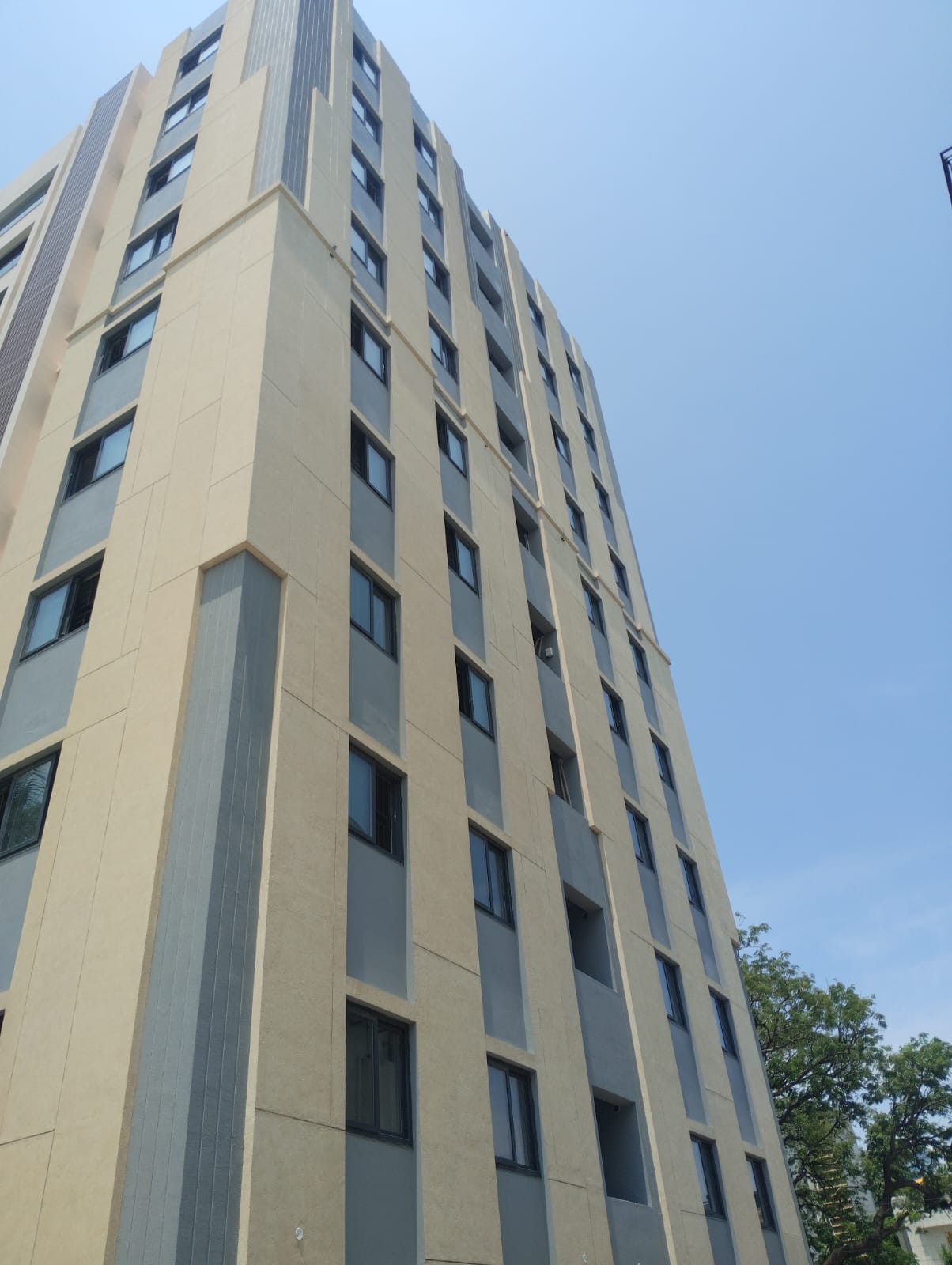

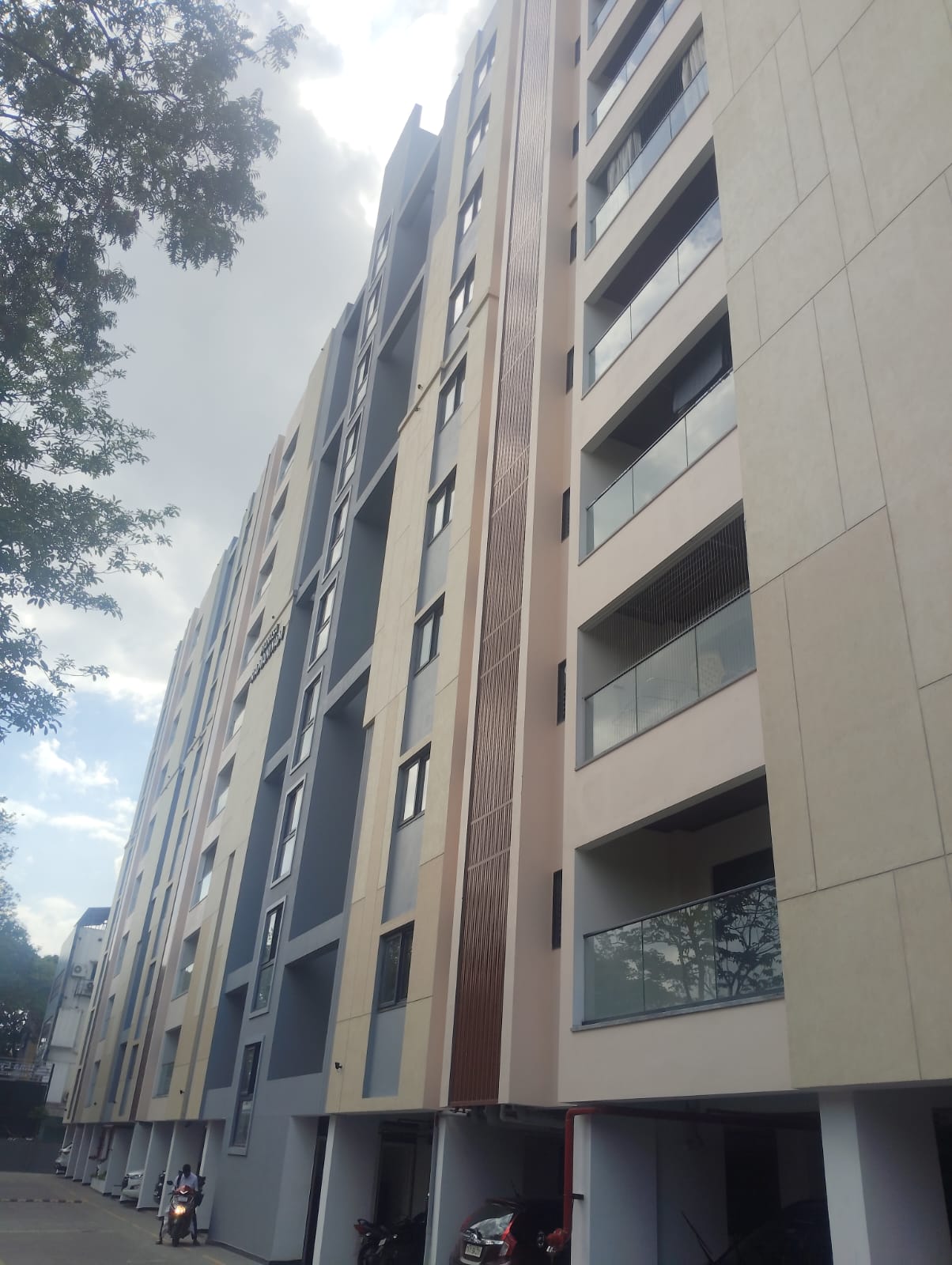

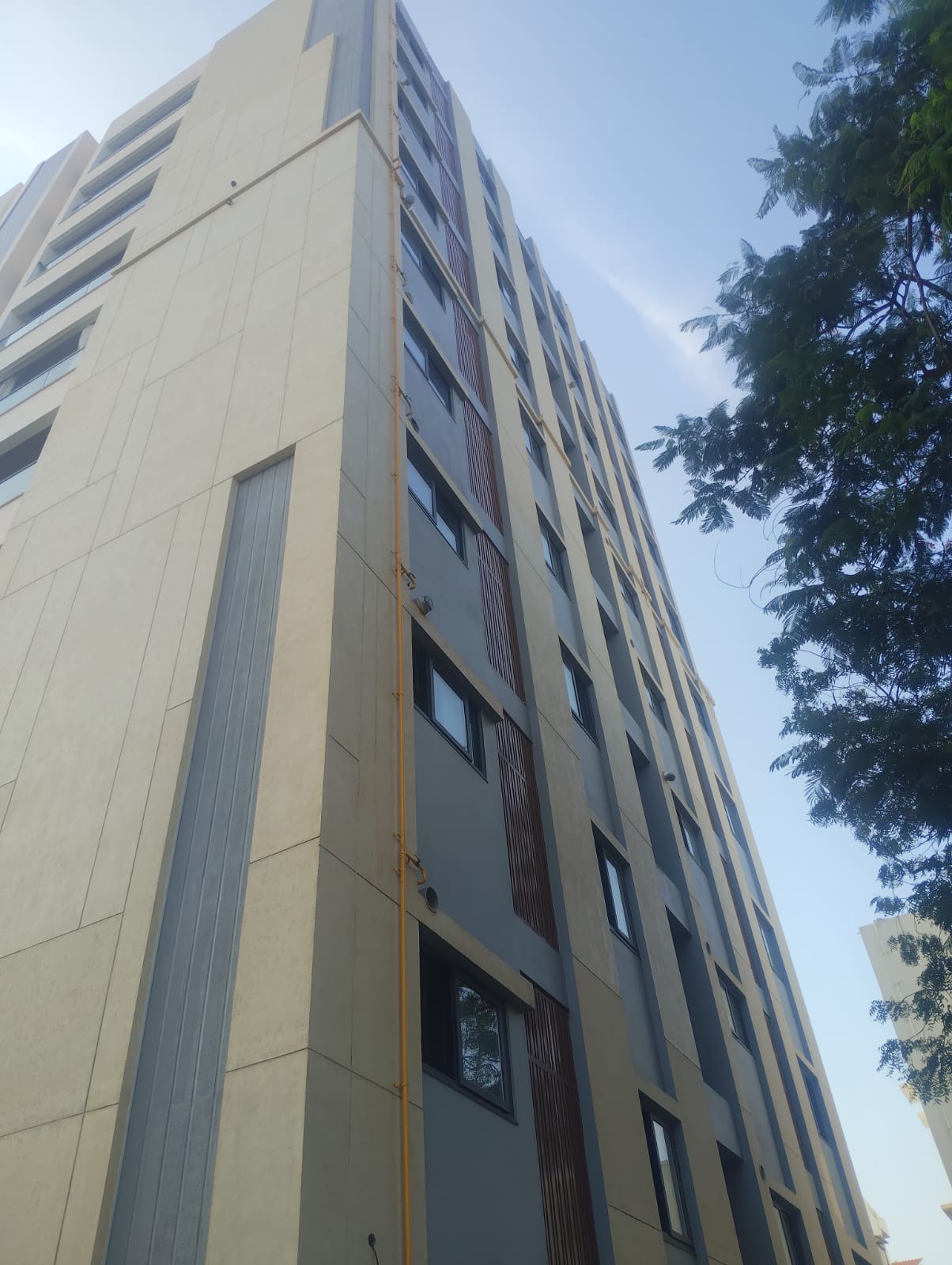

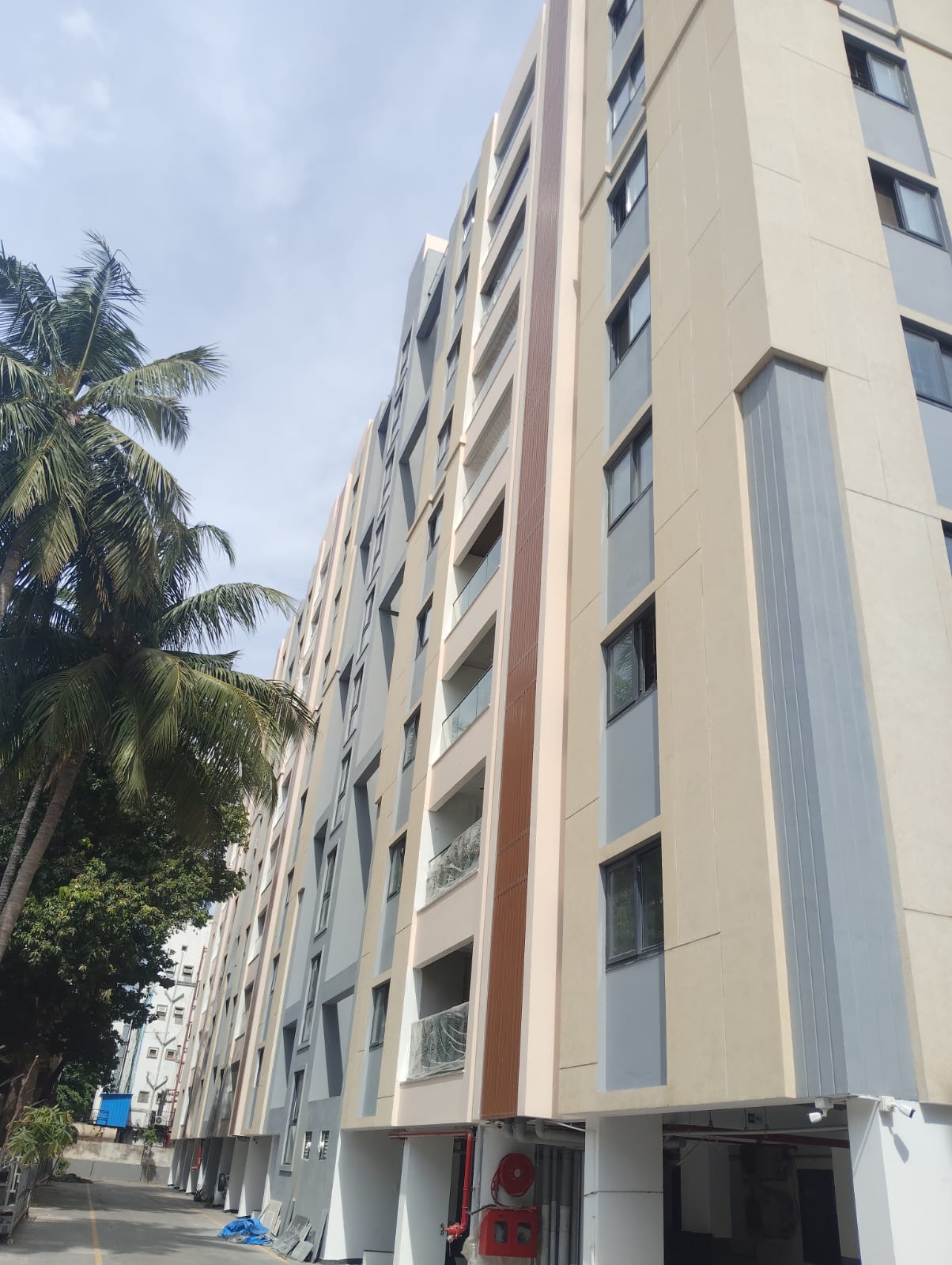

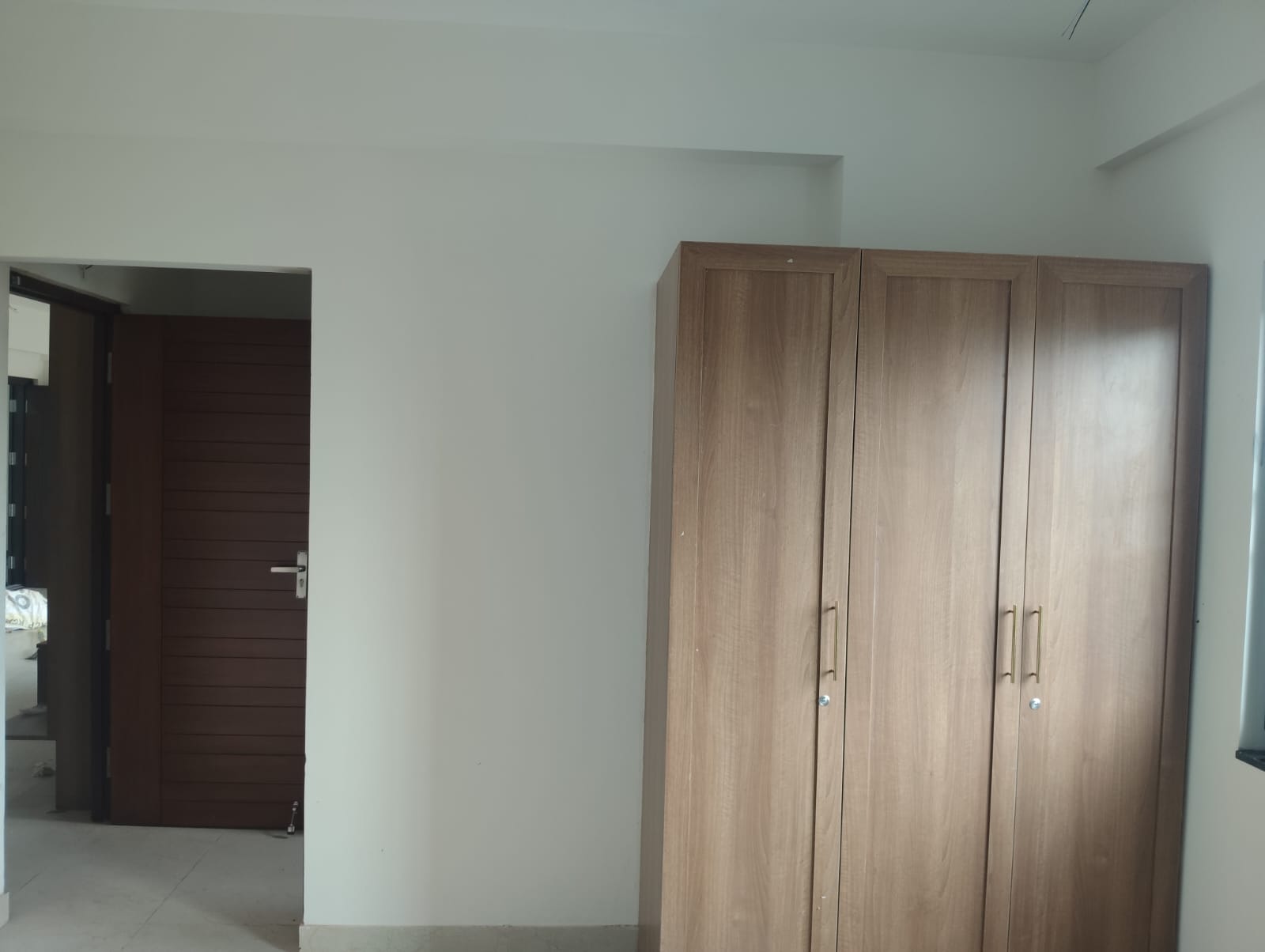

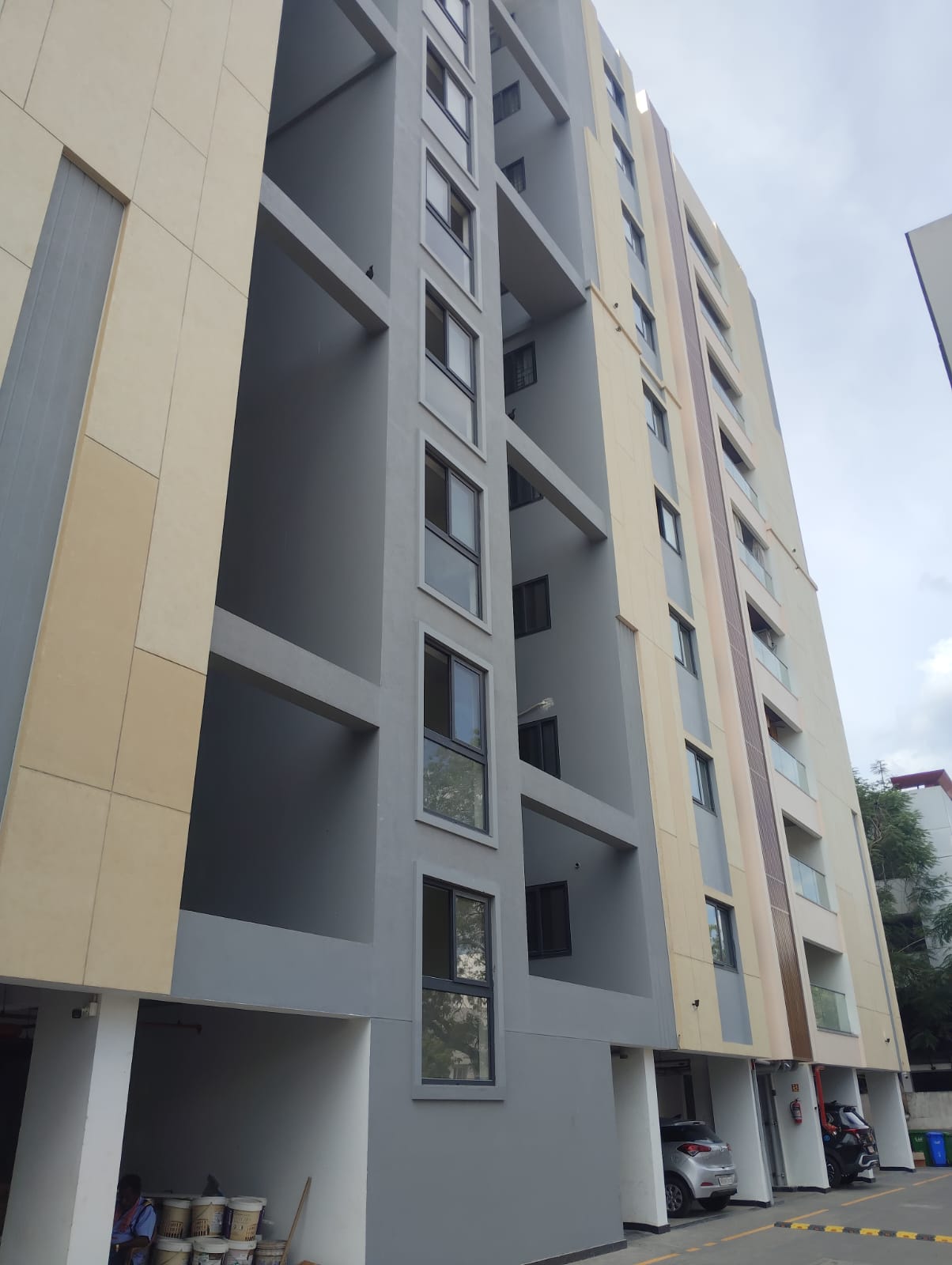

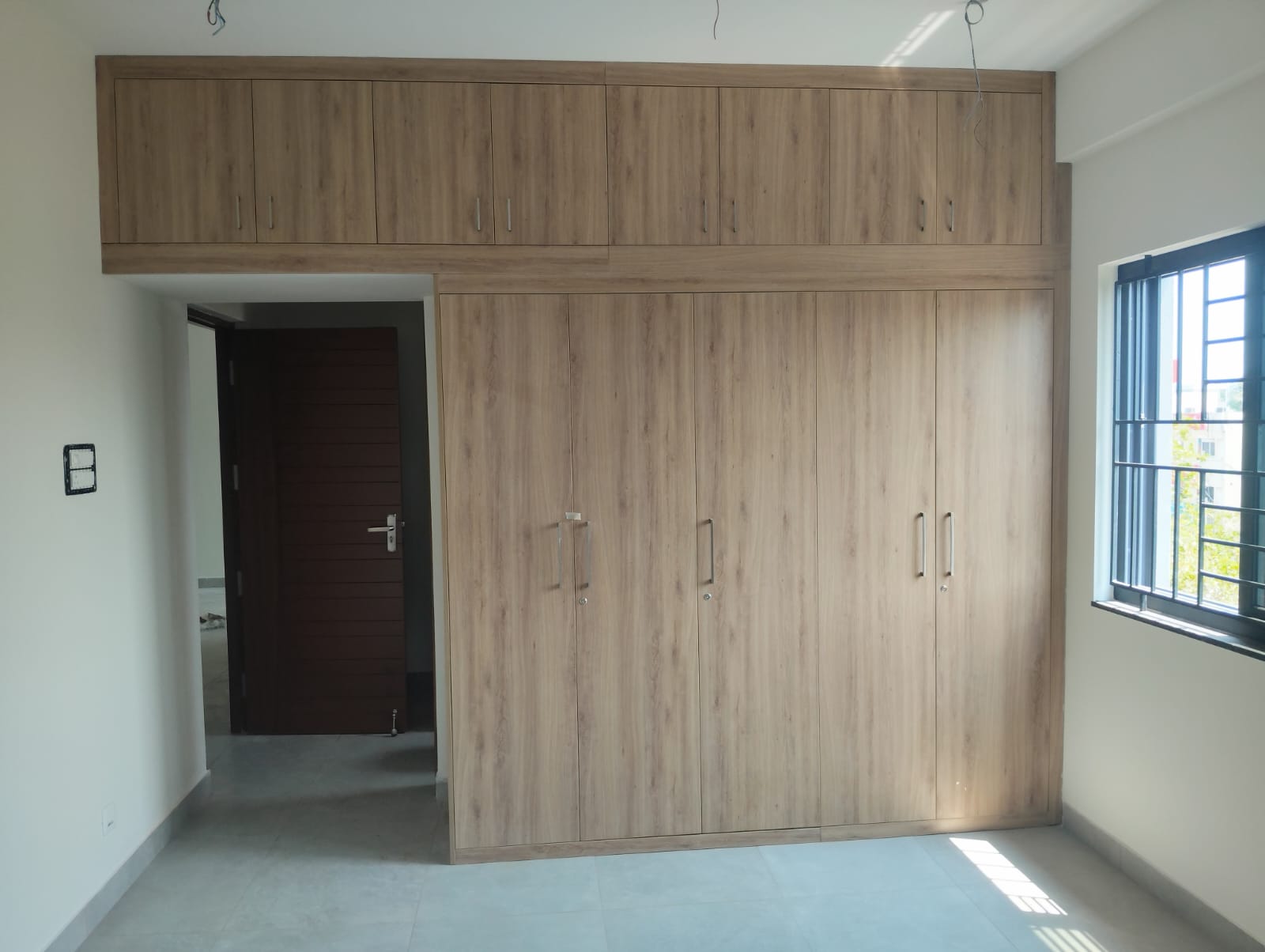

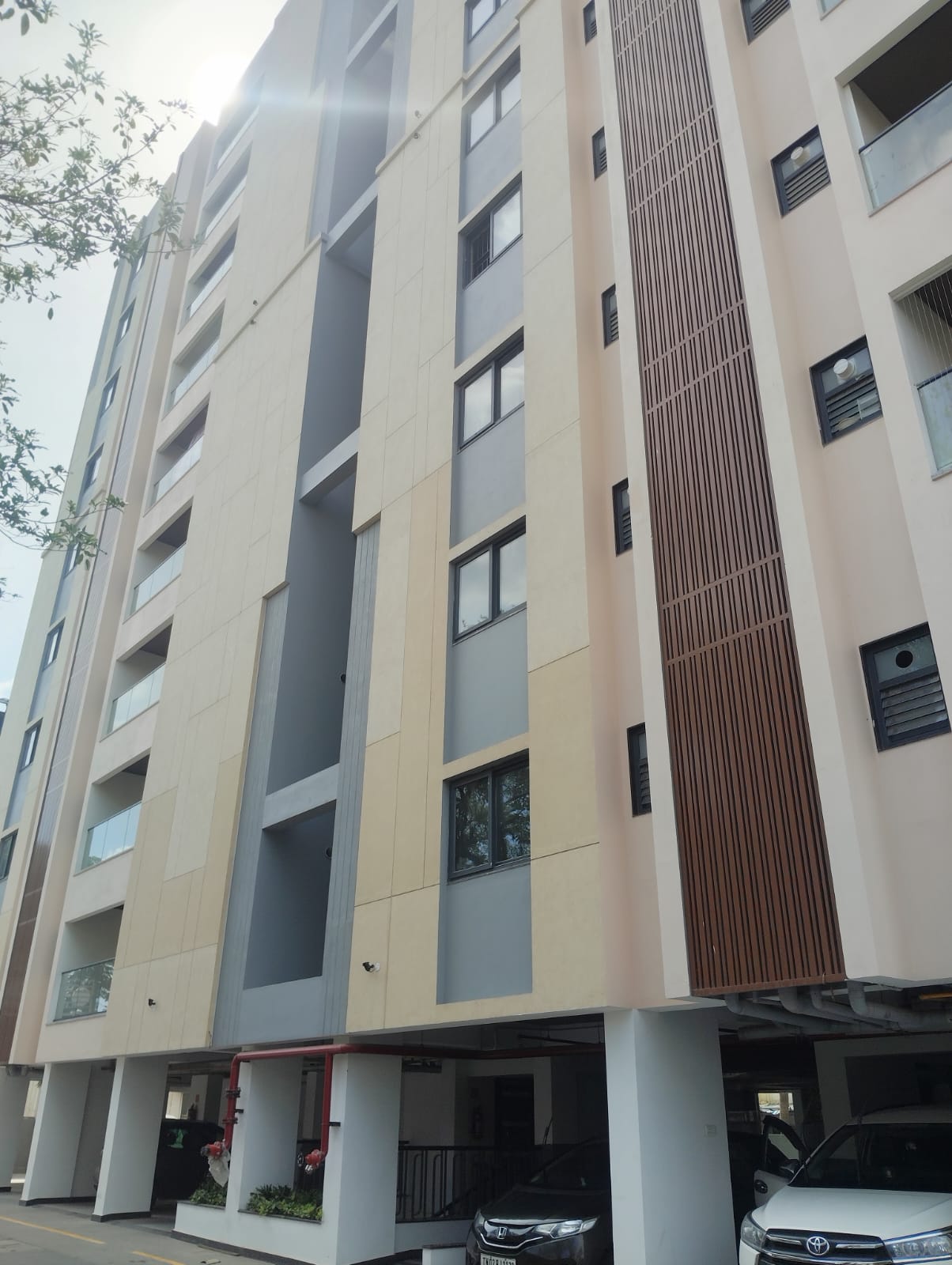

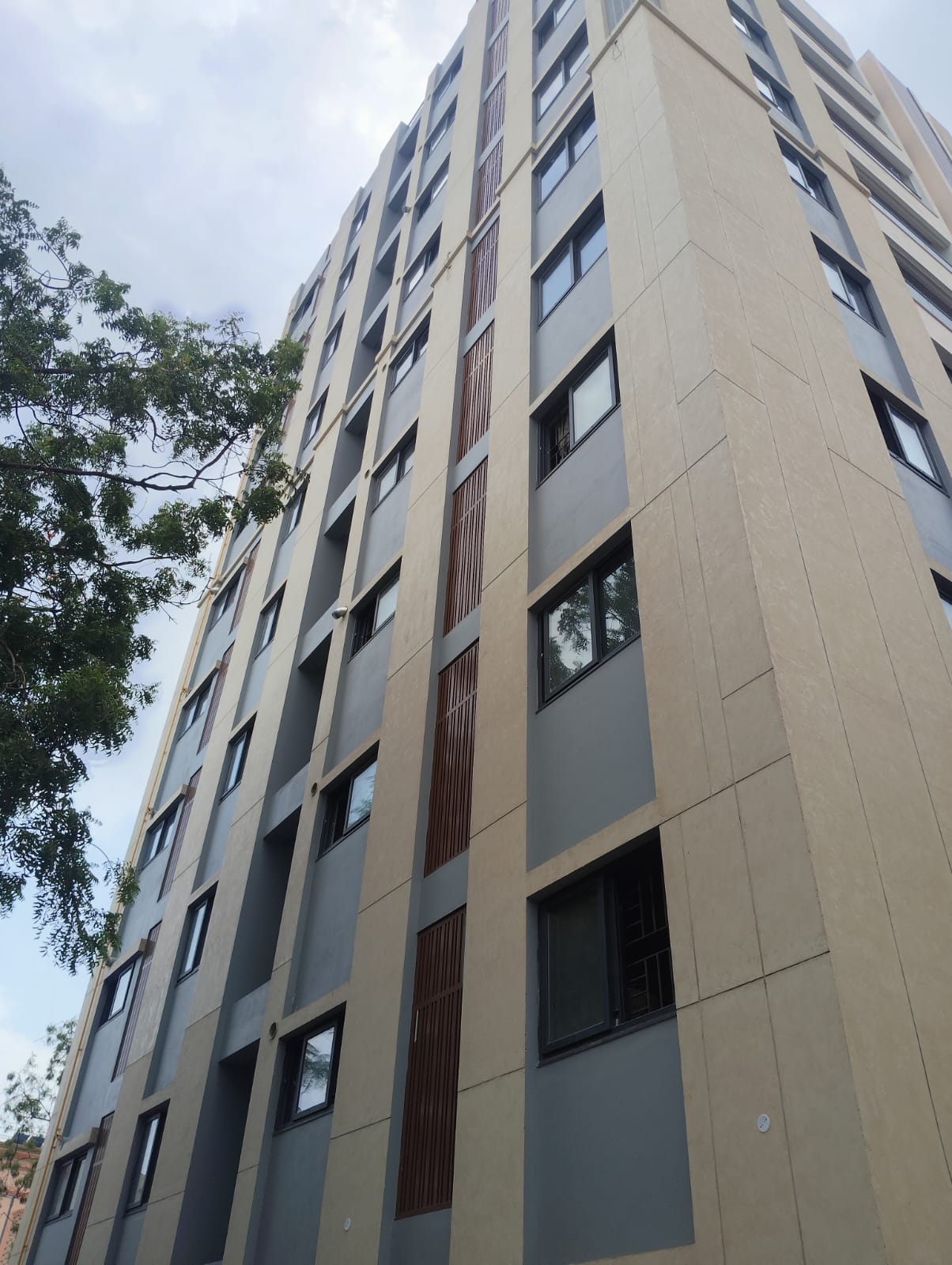

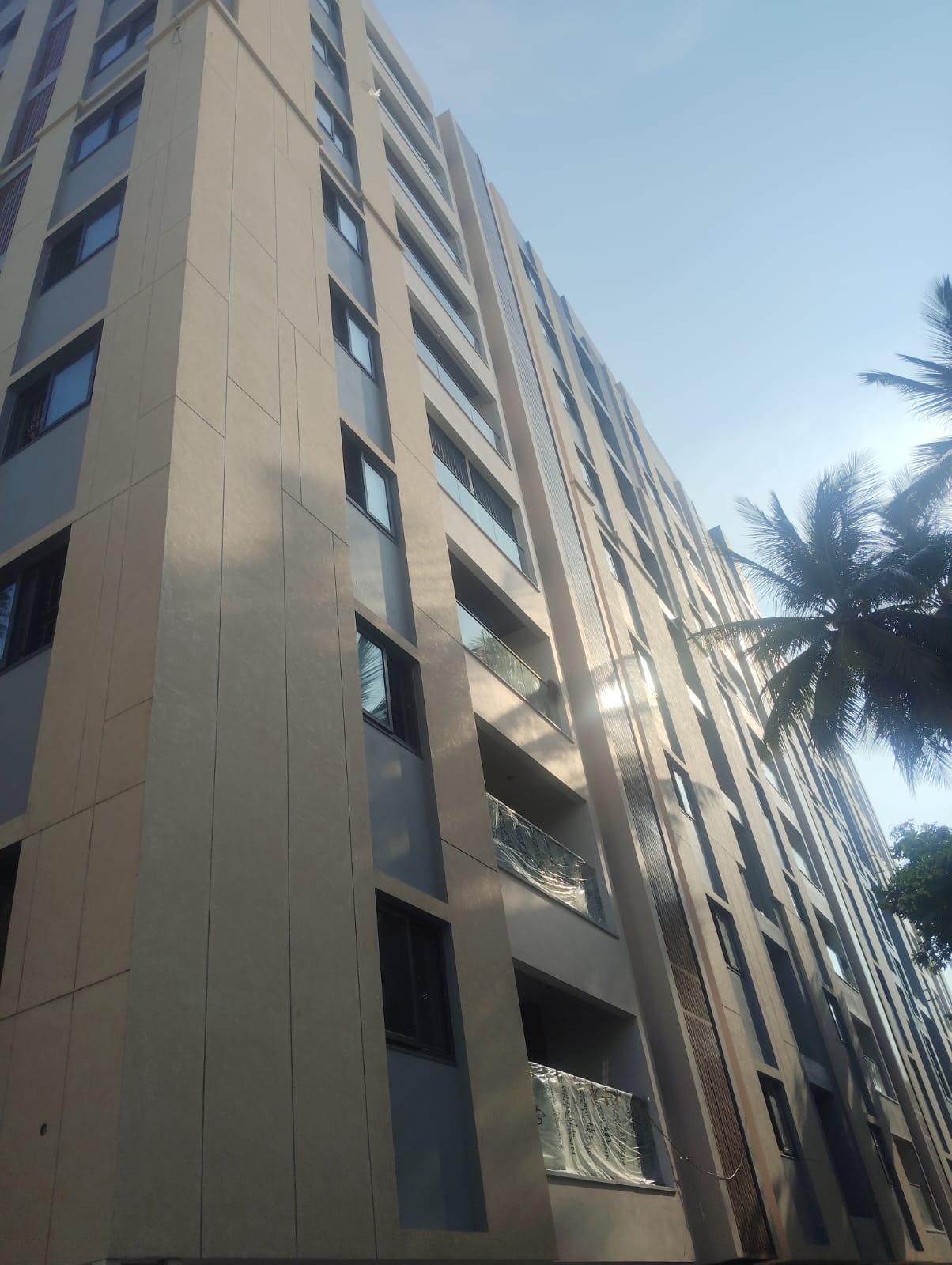

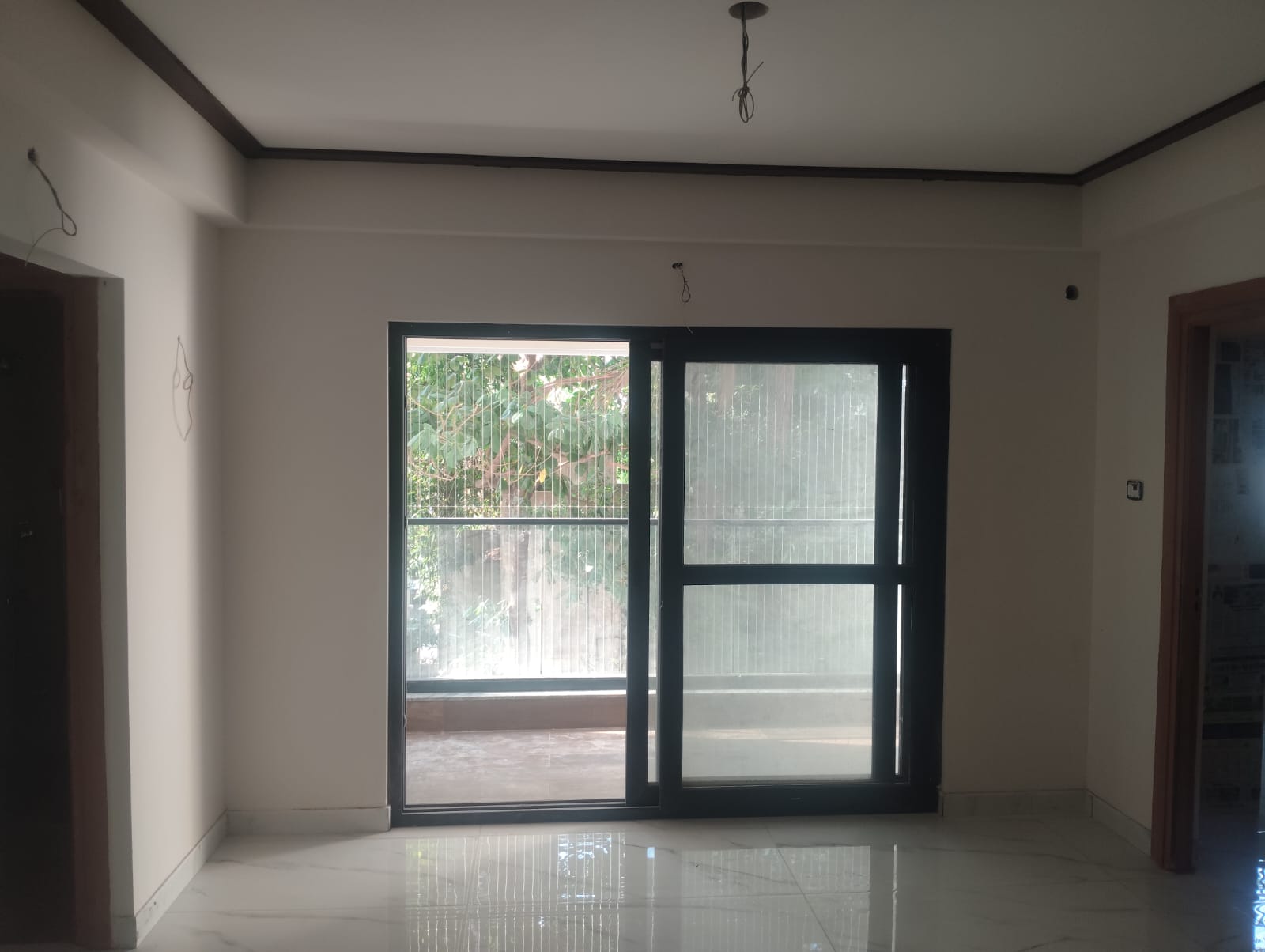

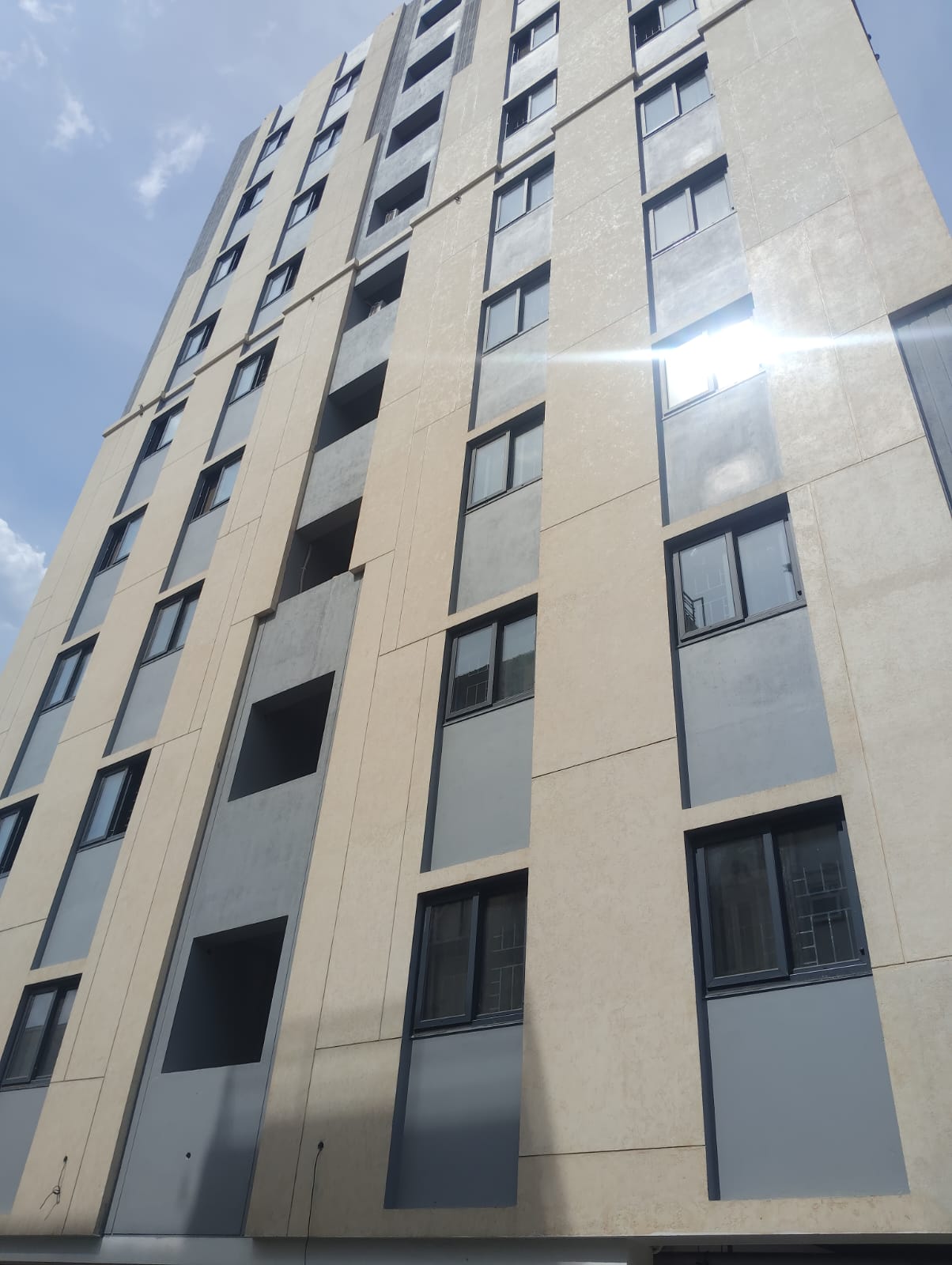

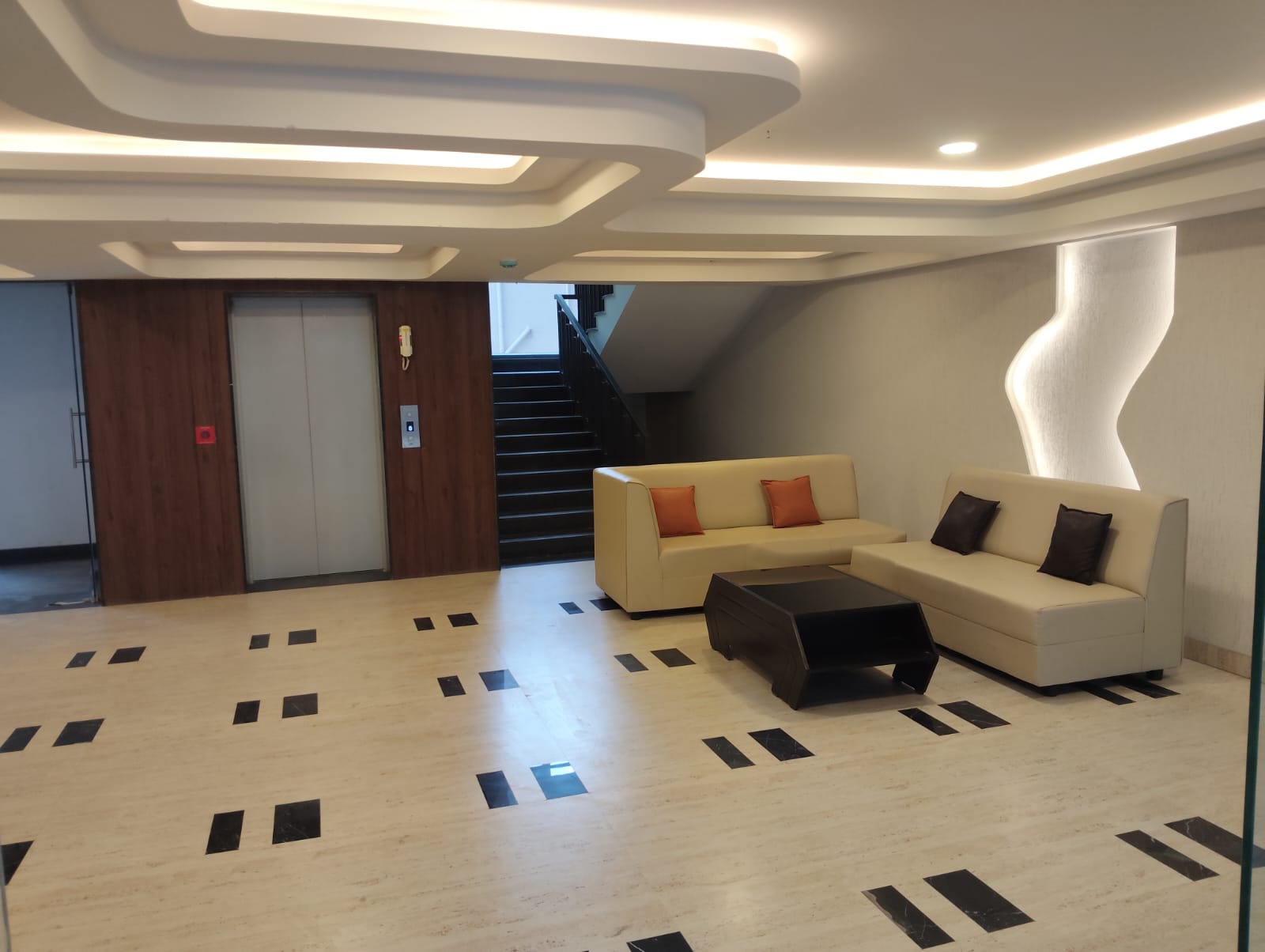

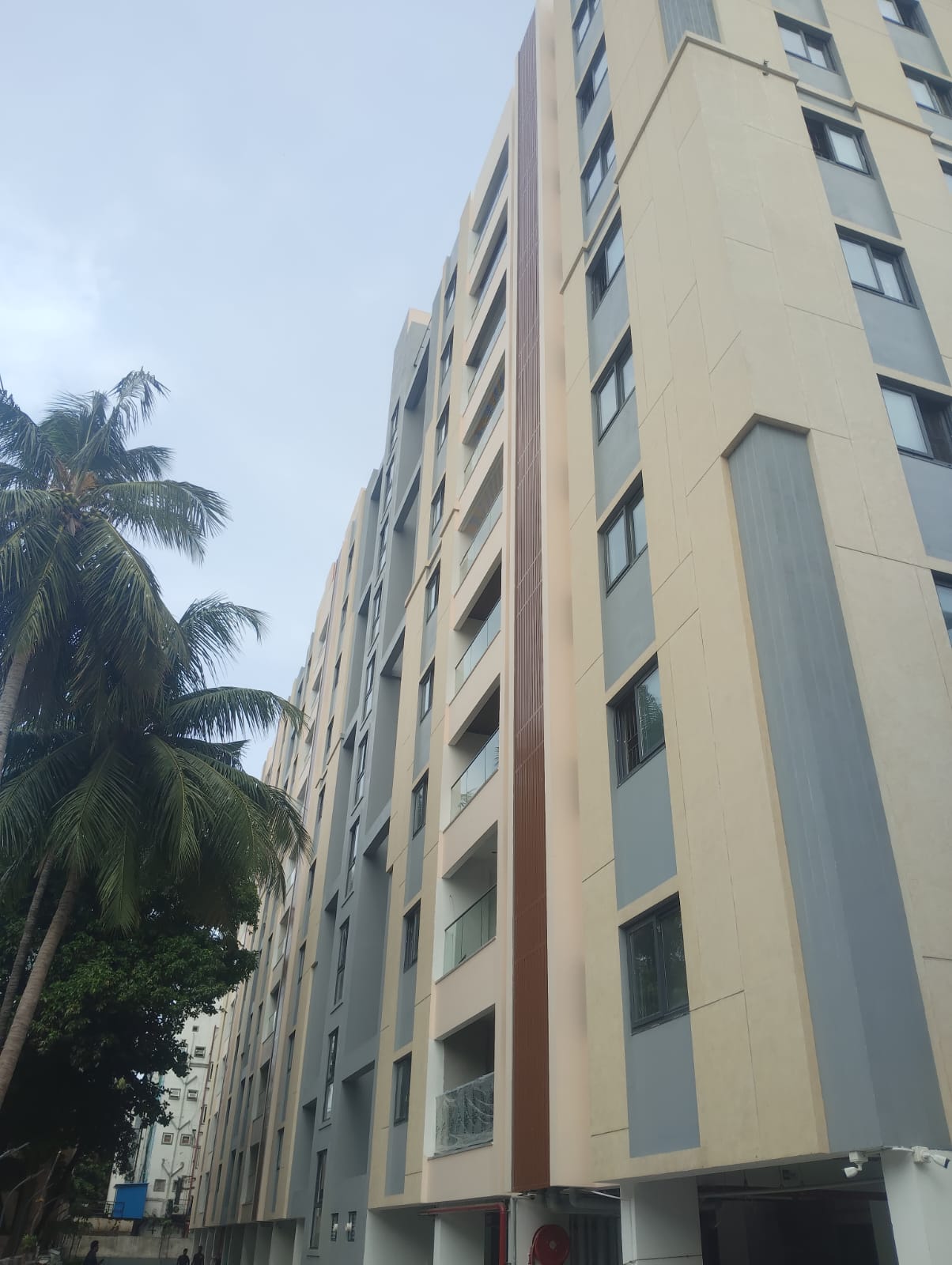

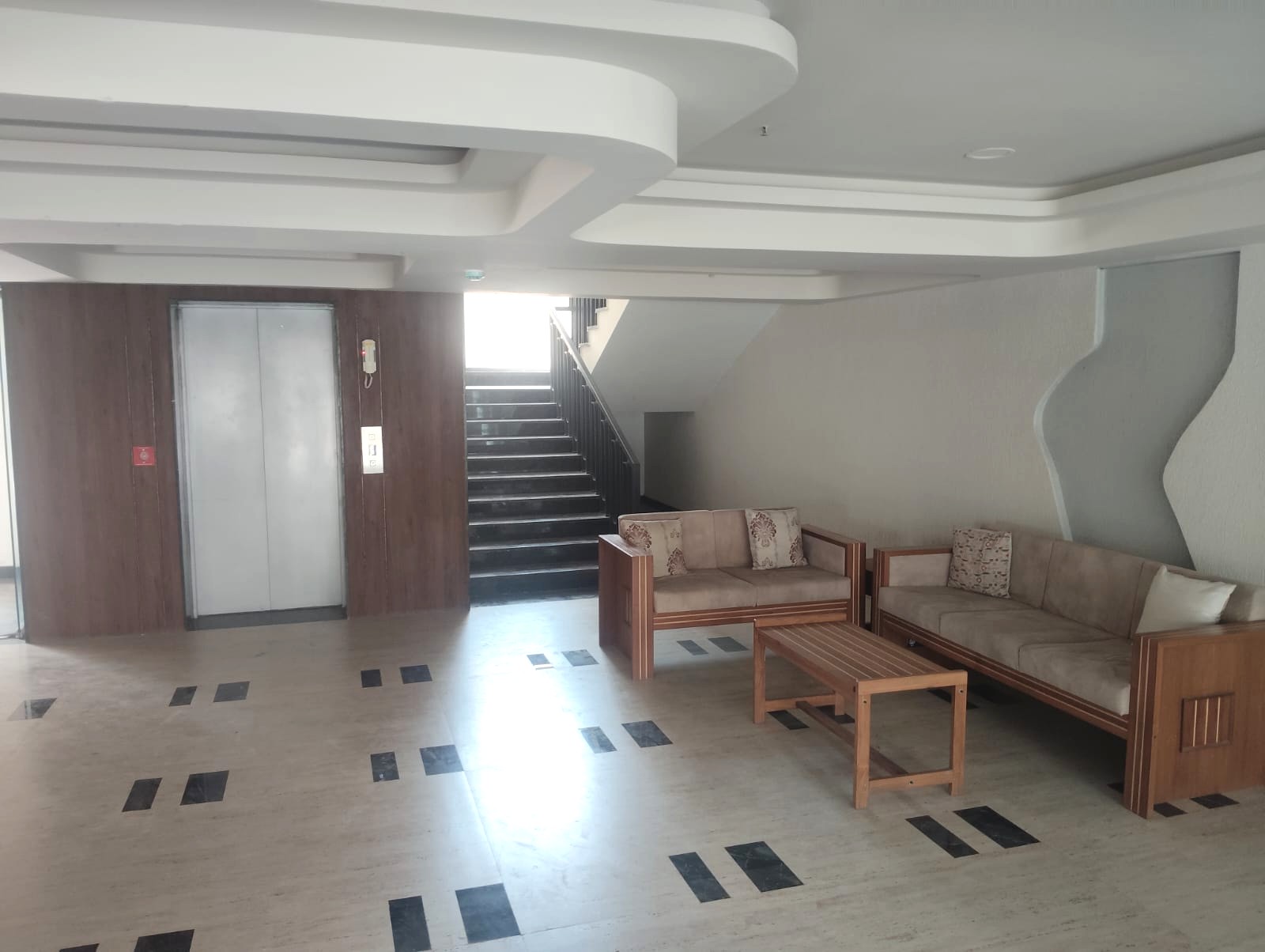

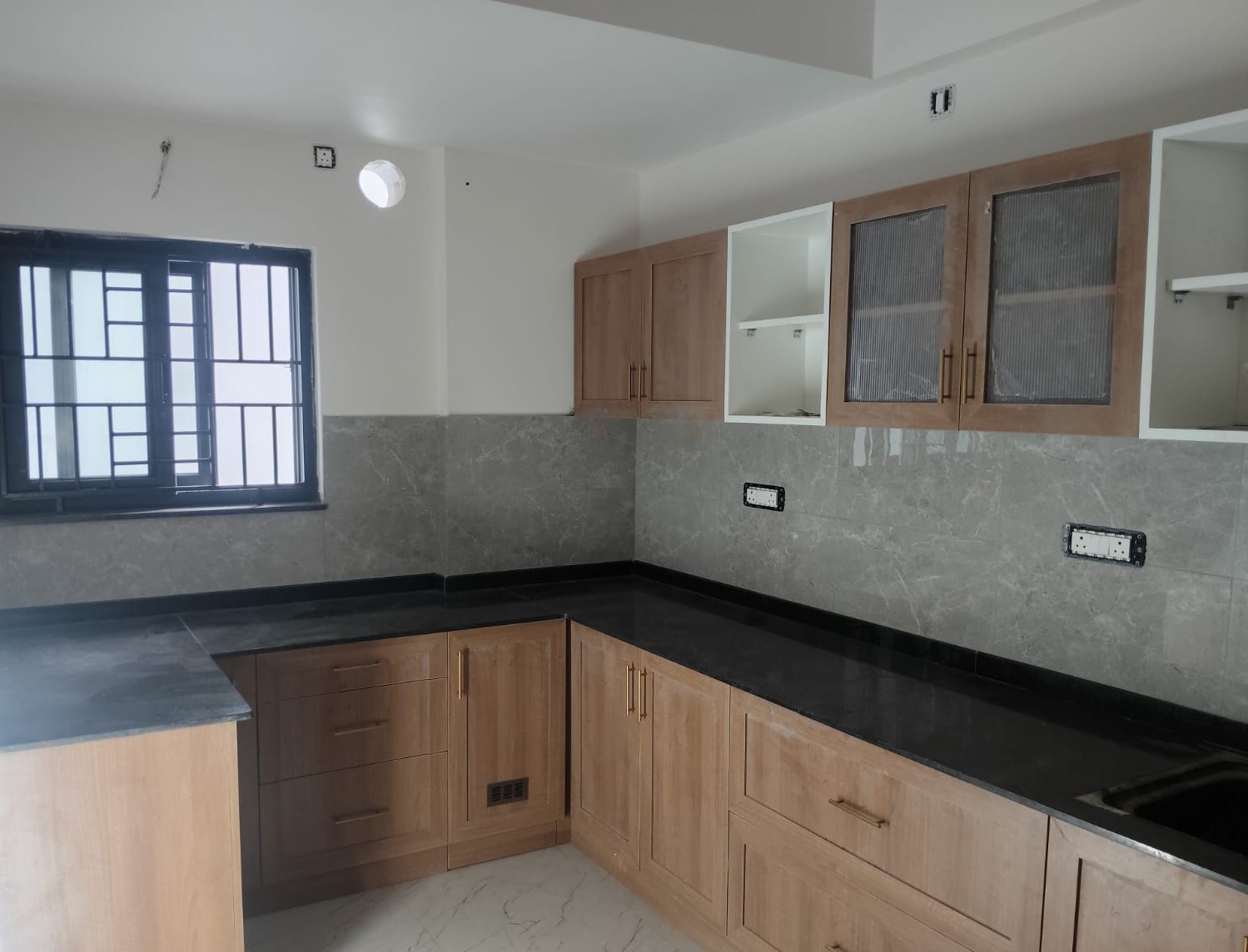

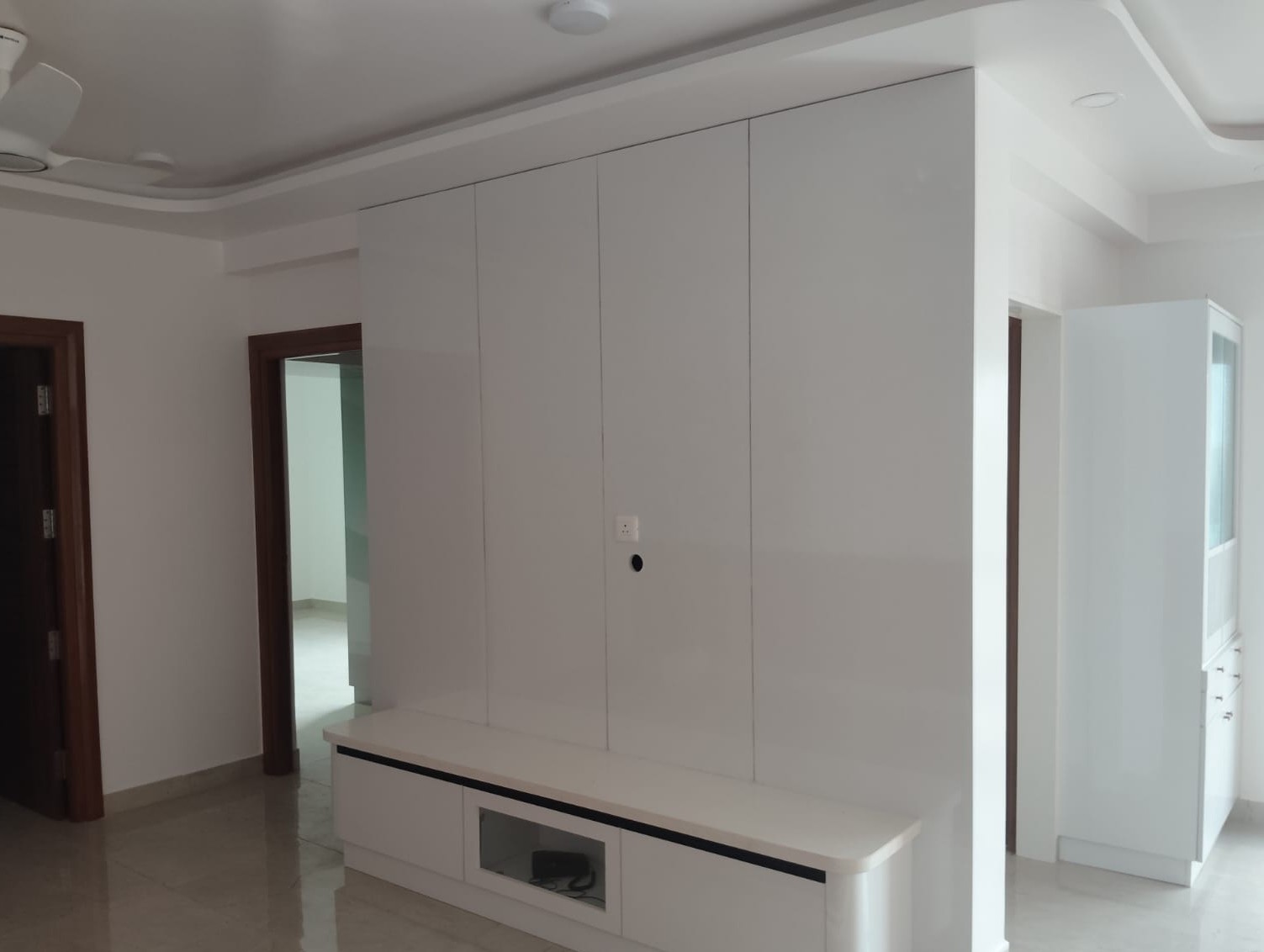

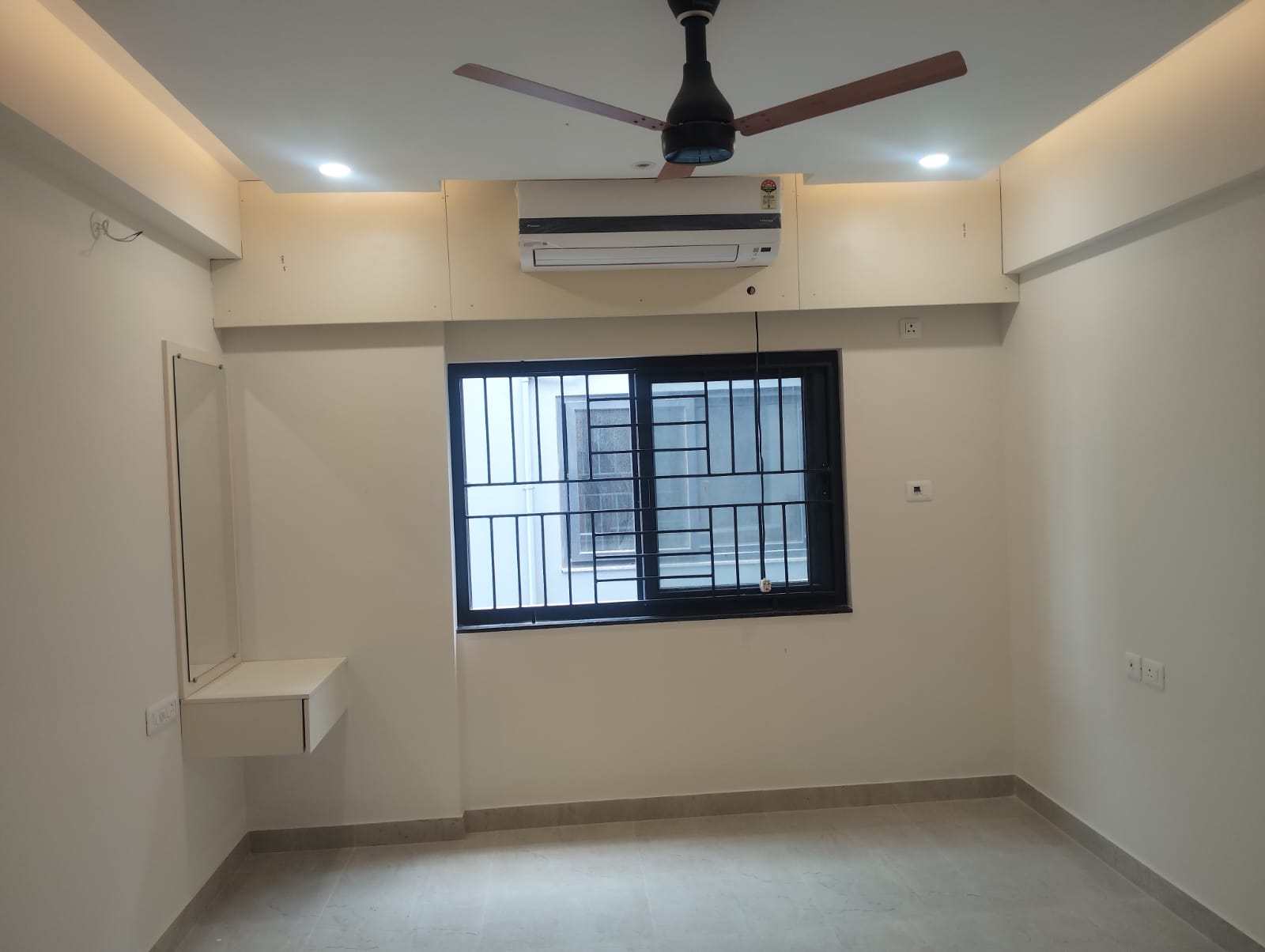

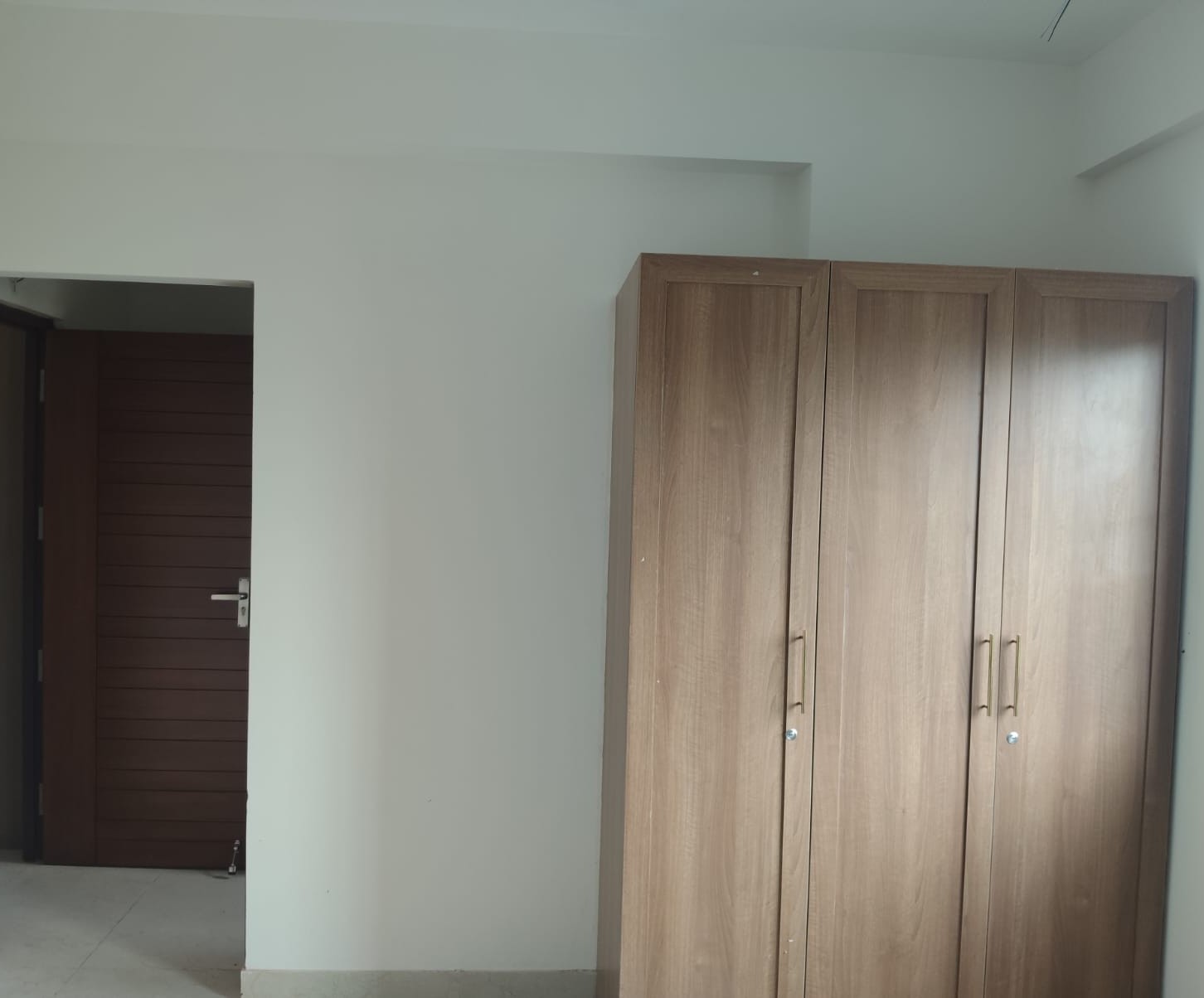

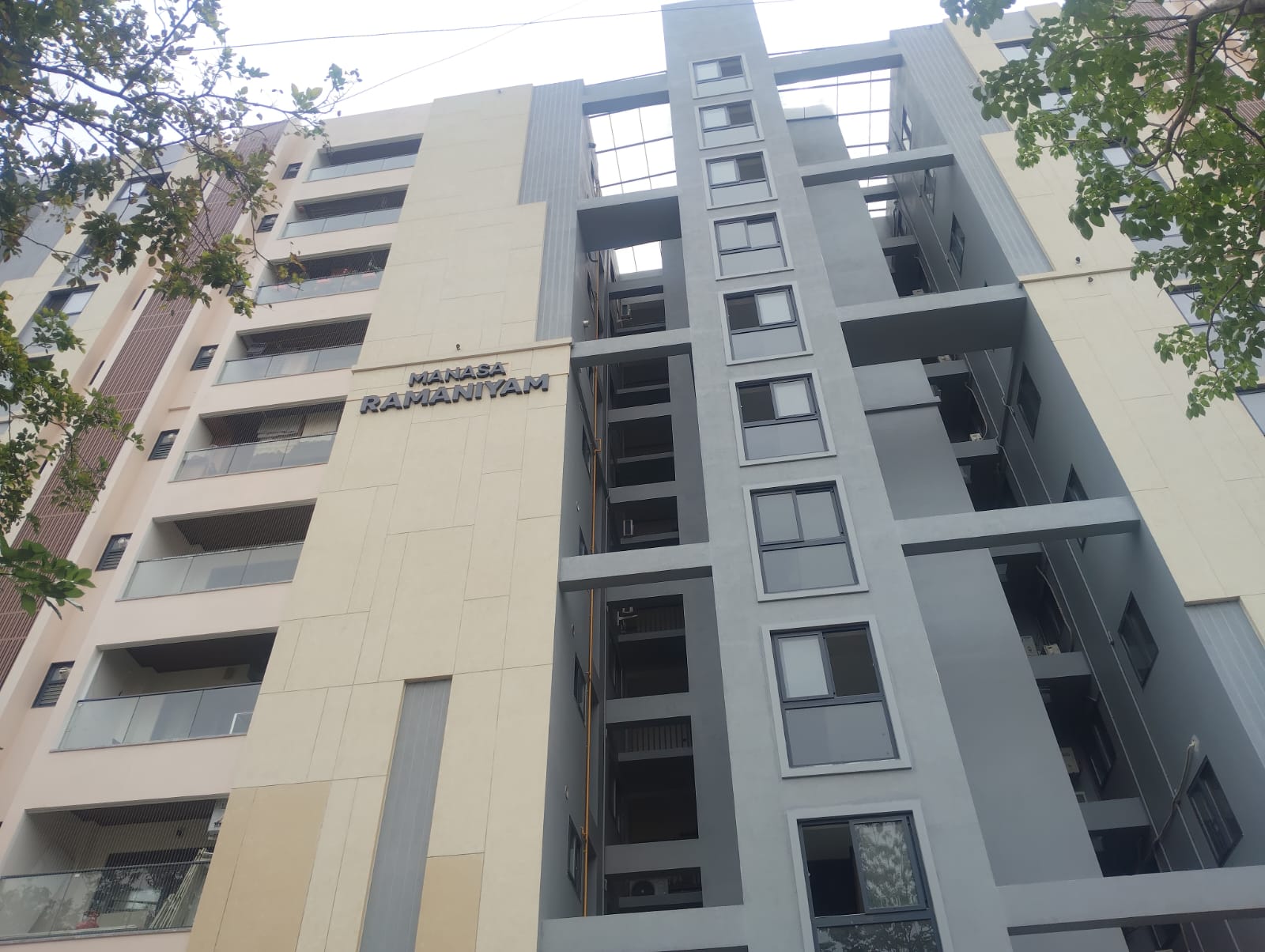

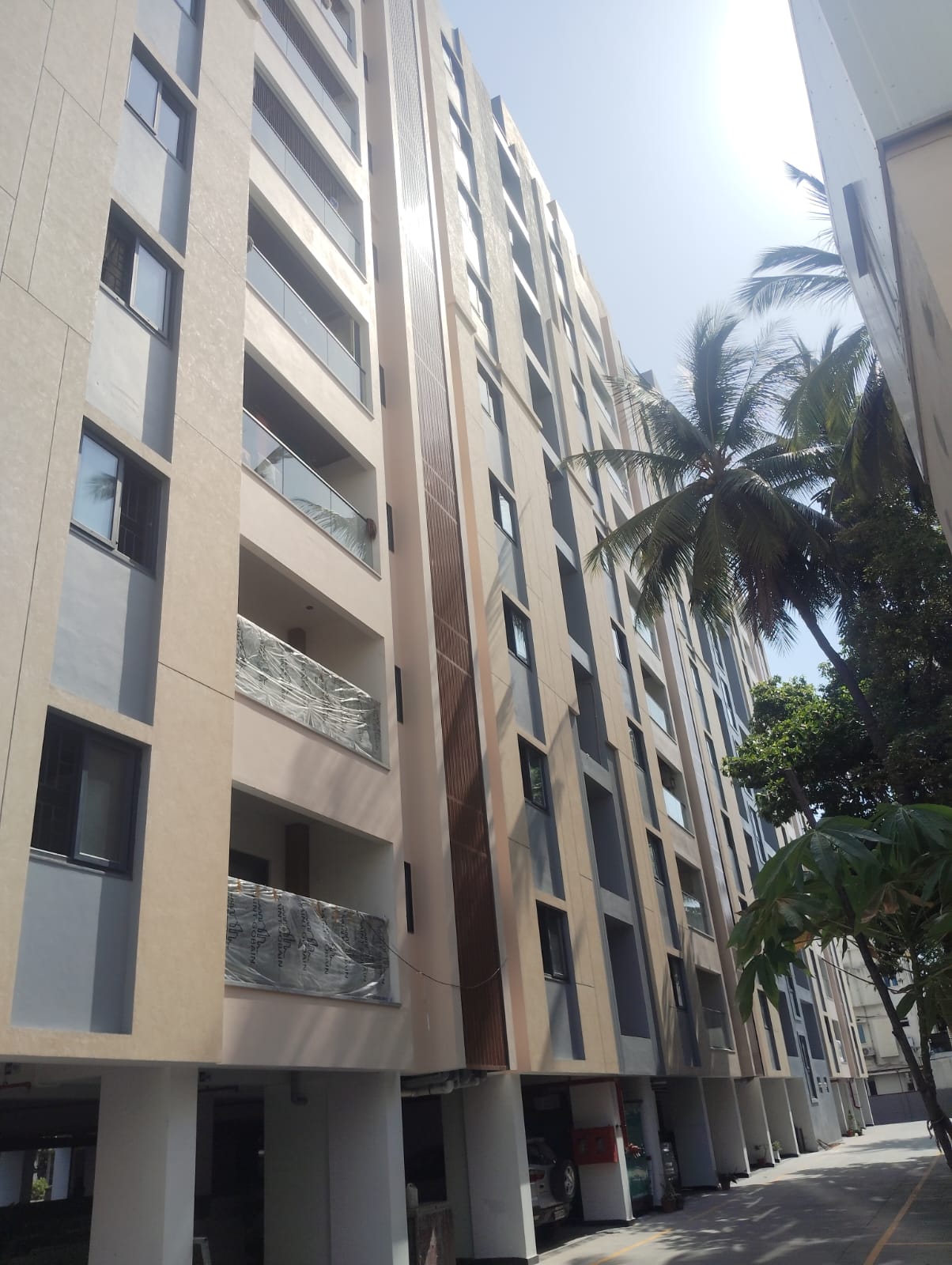

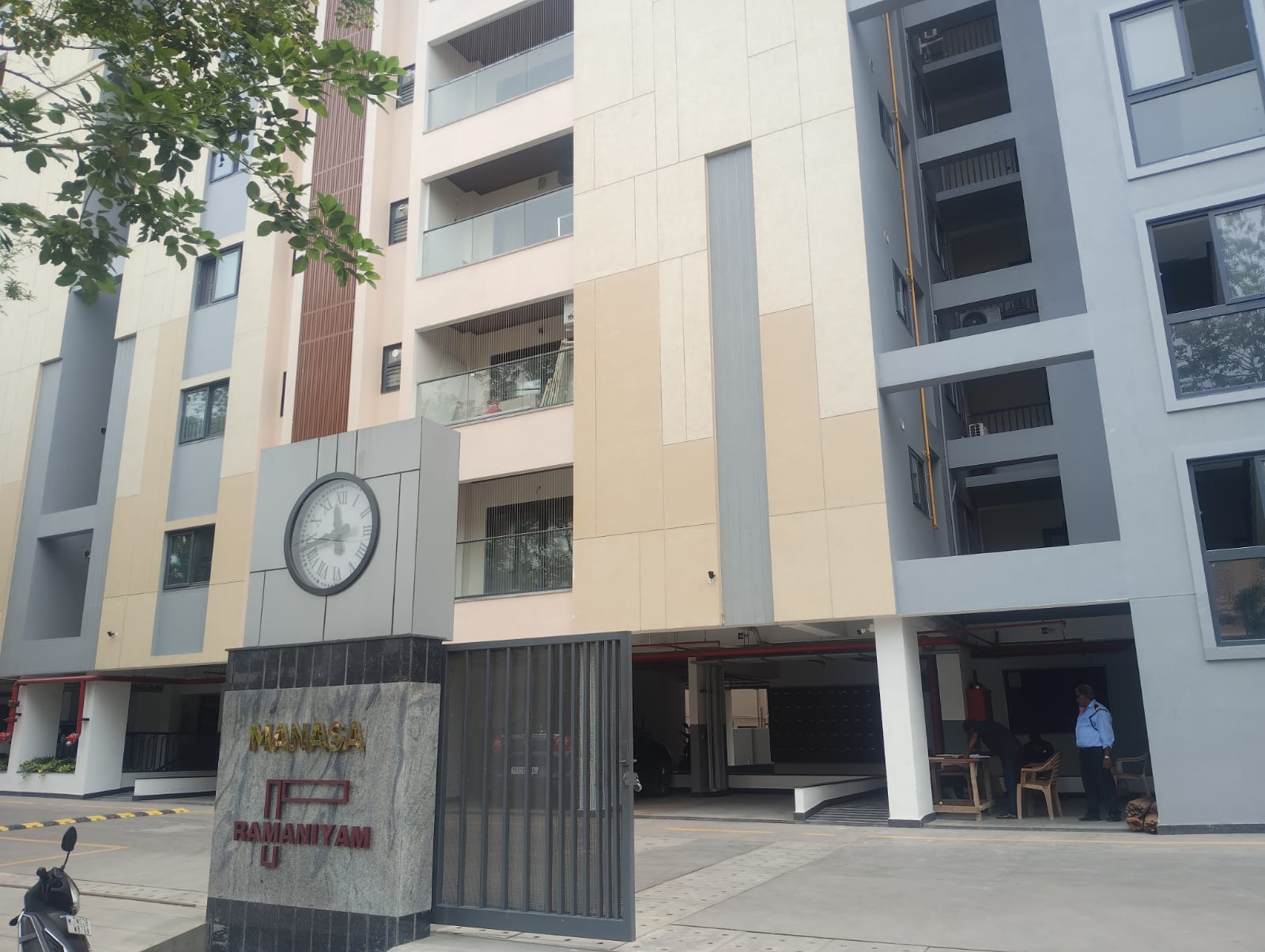

Project Update Images

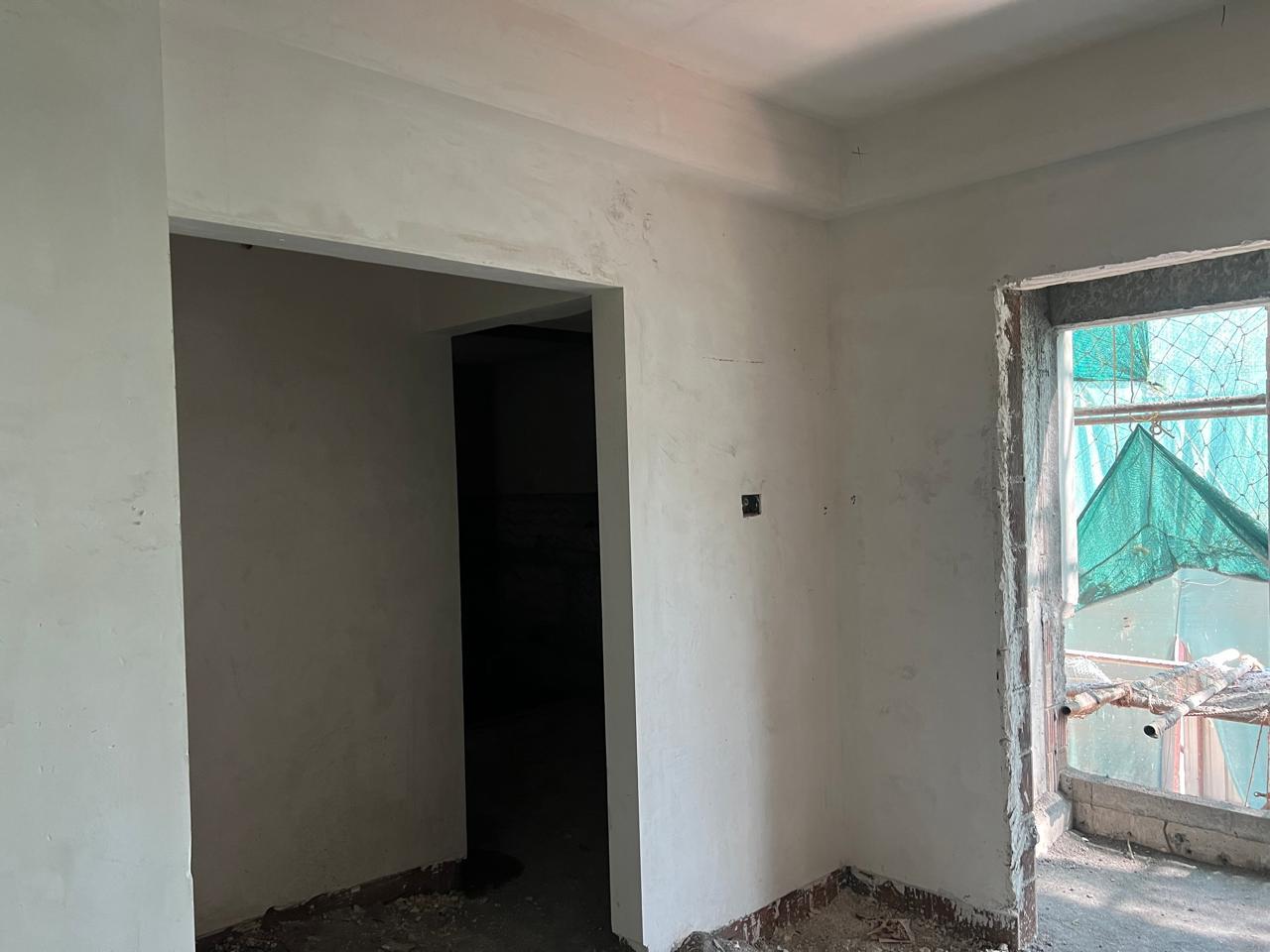

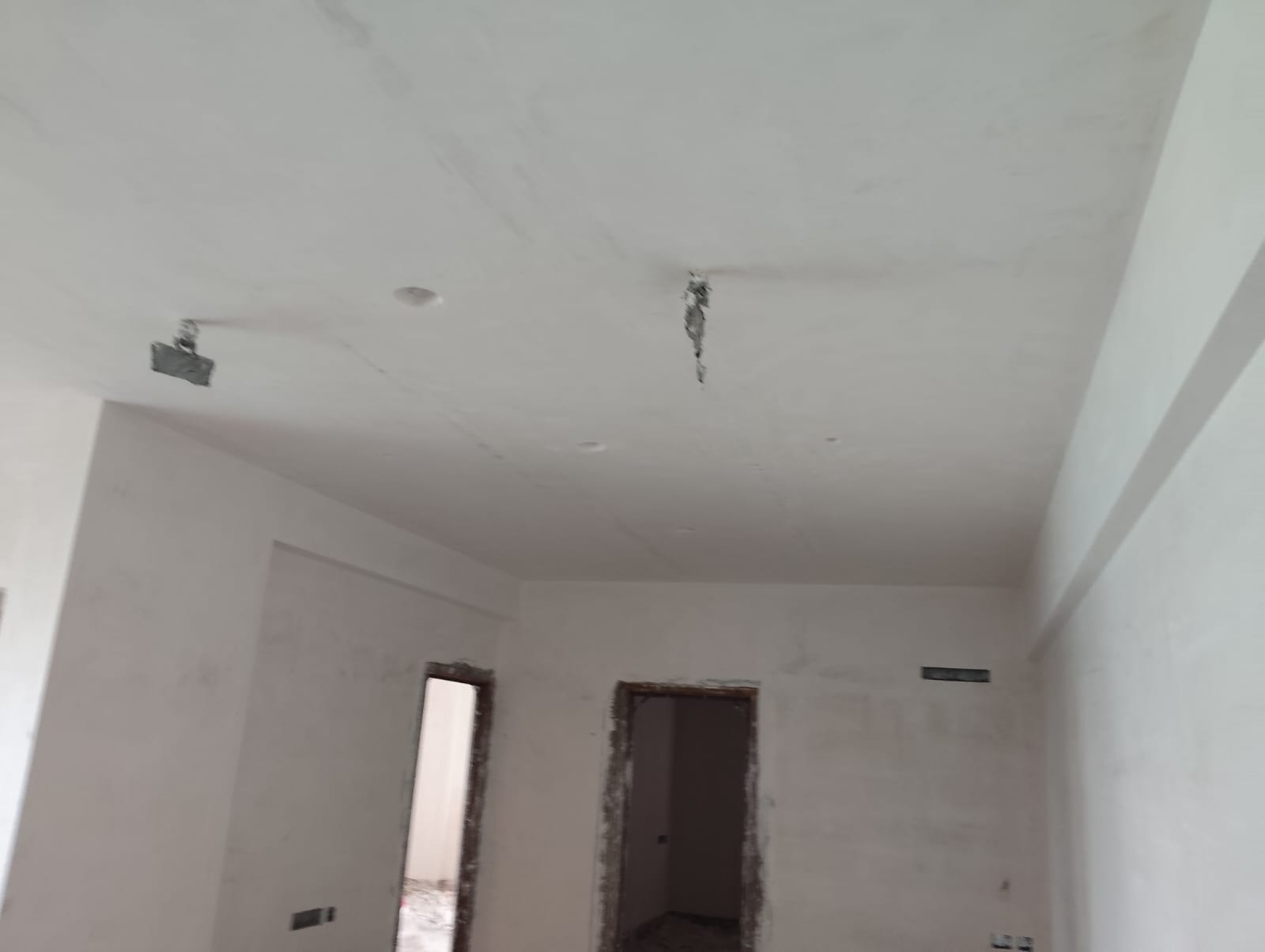

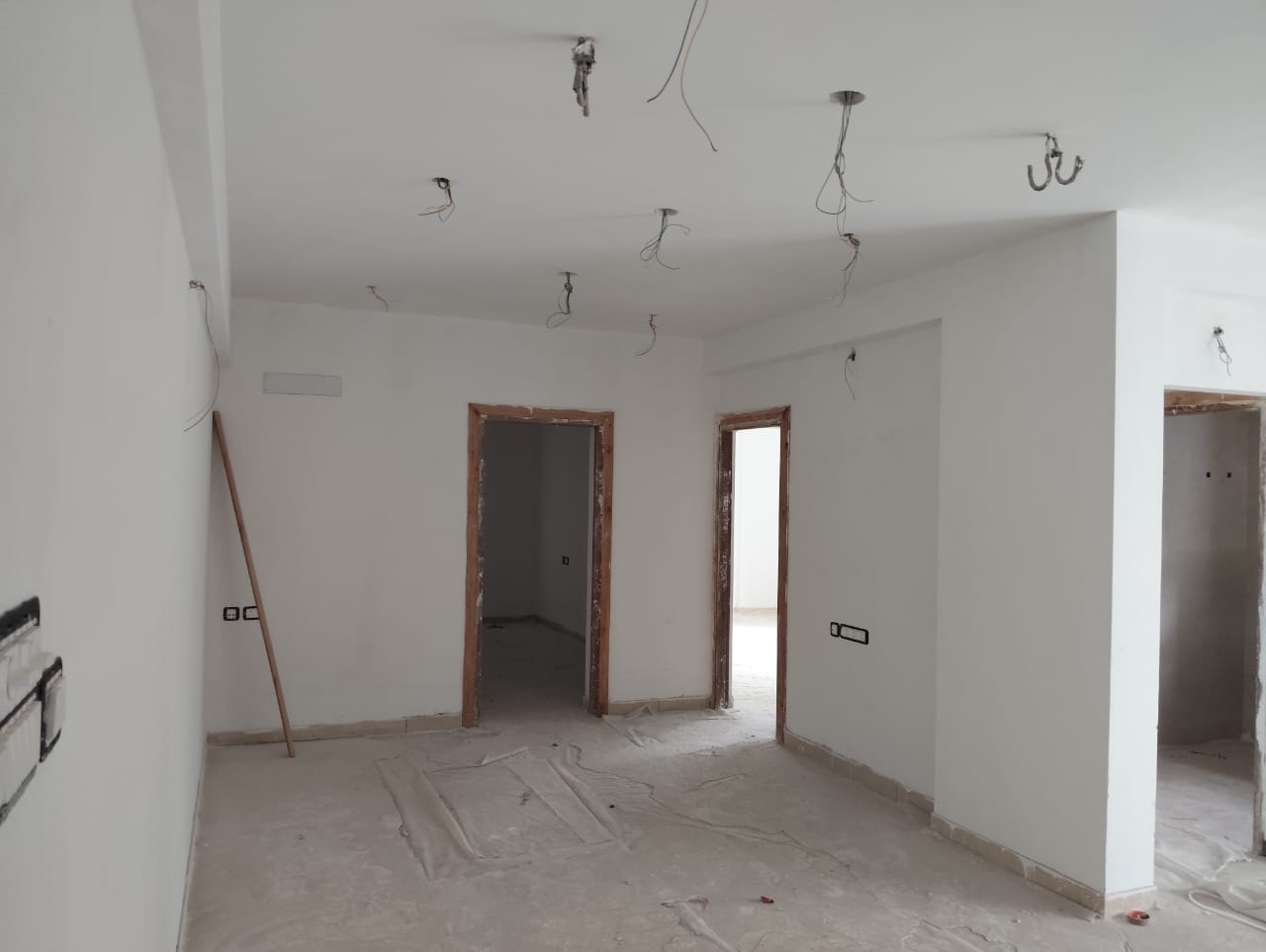

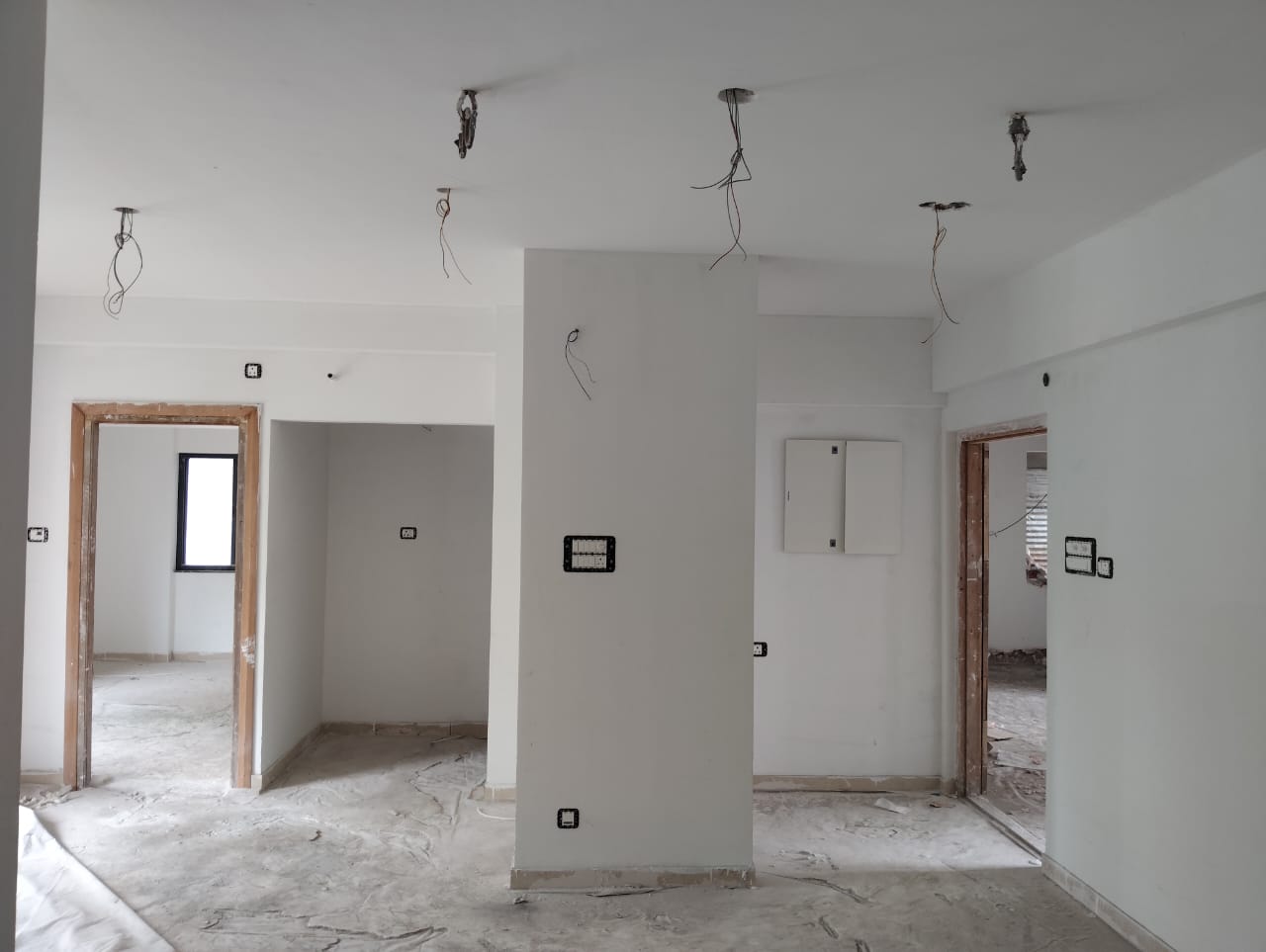

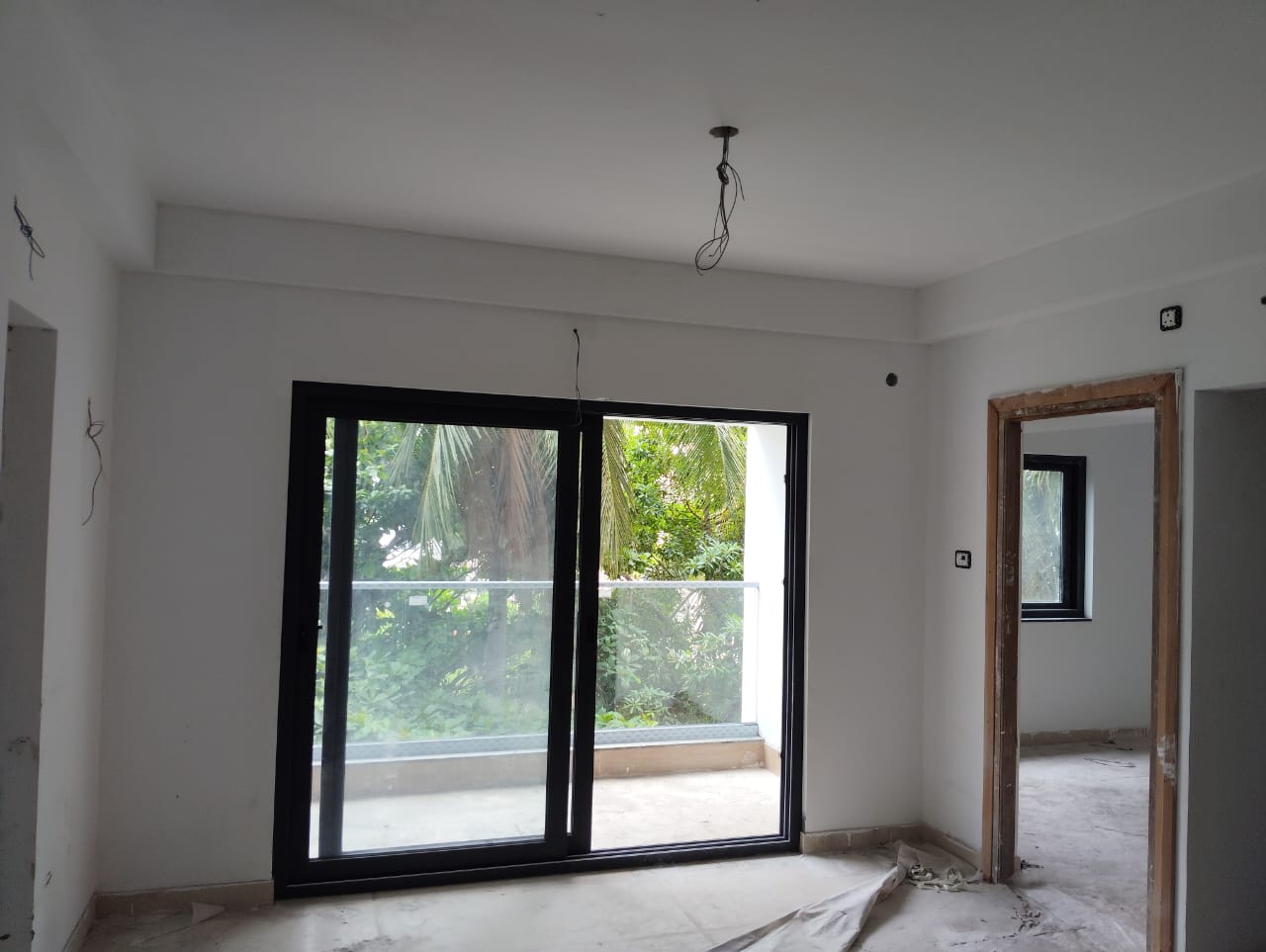

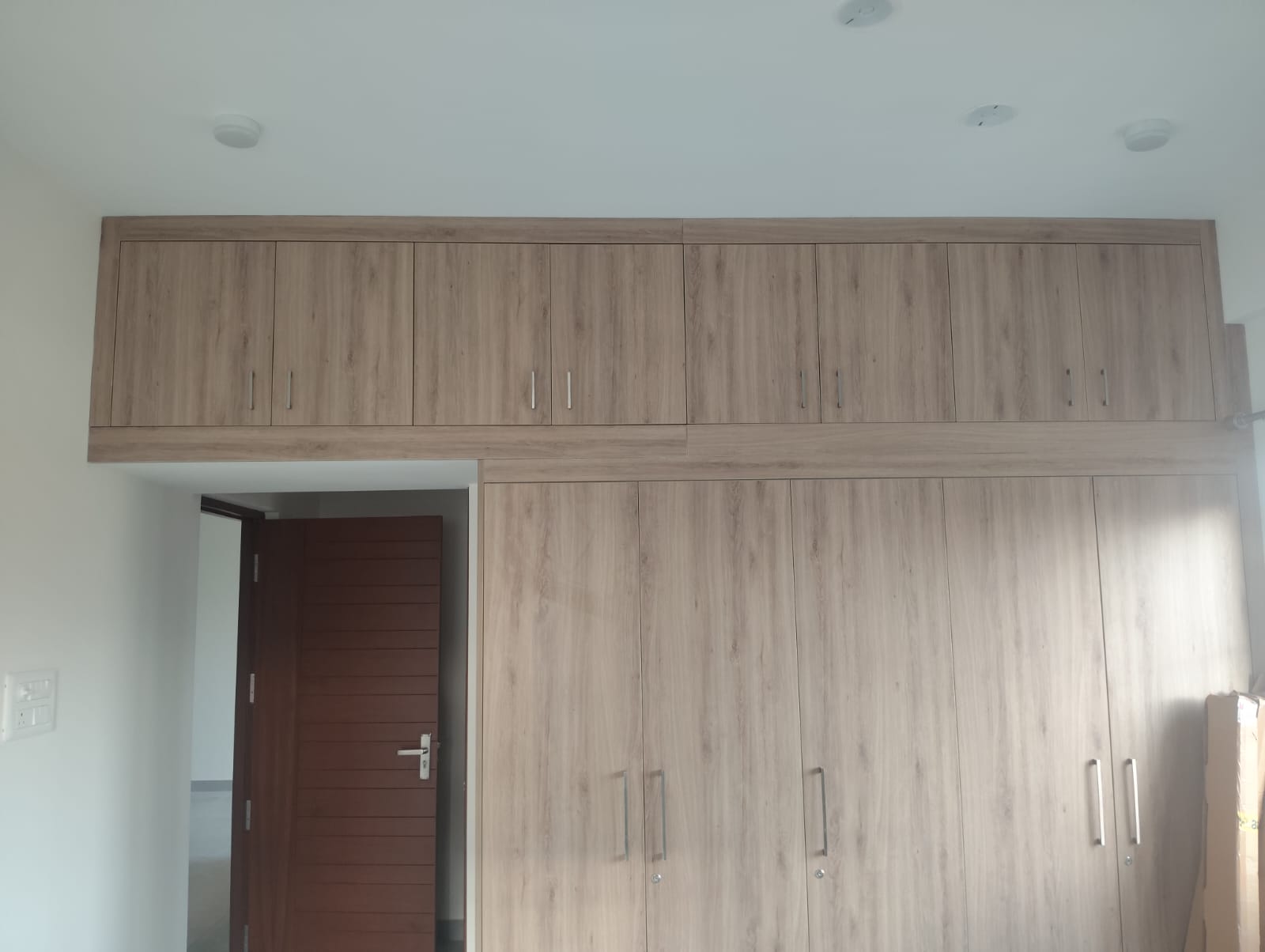

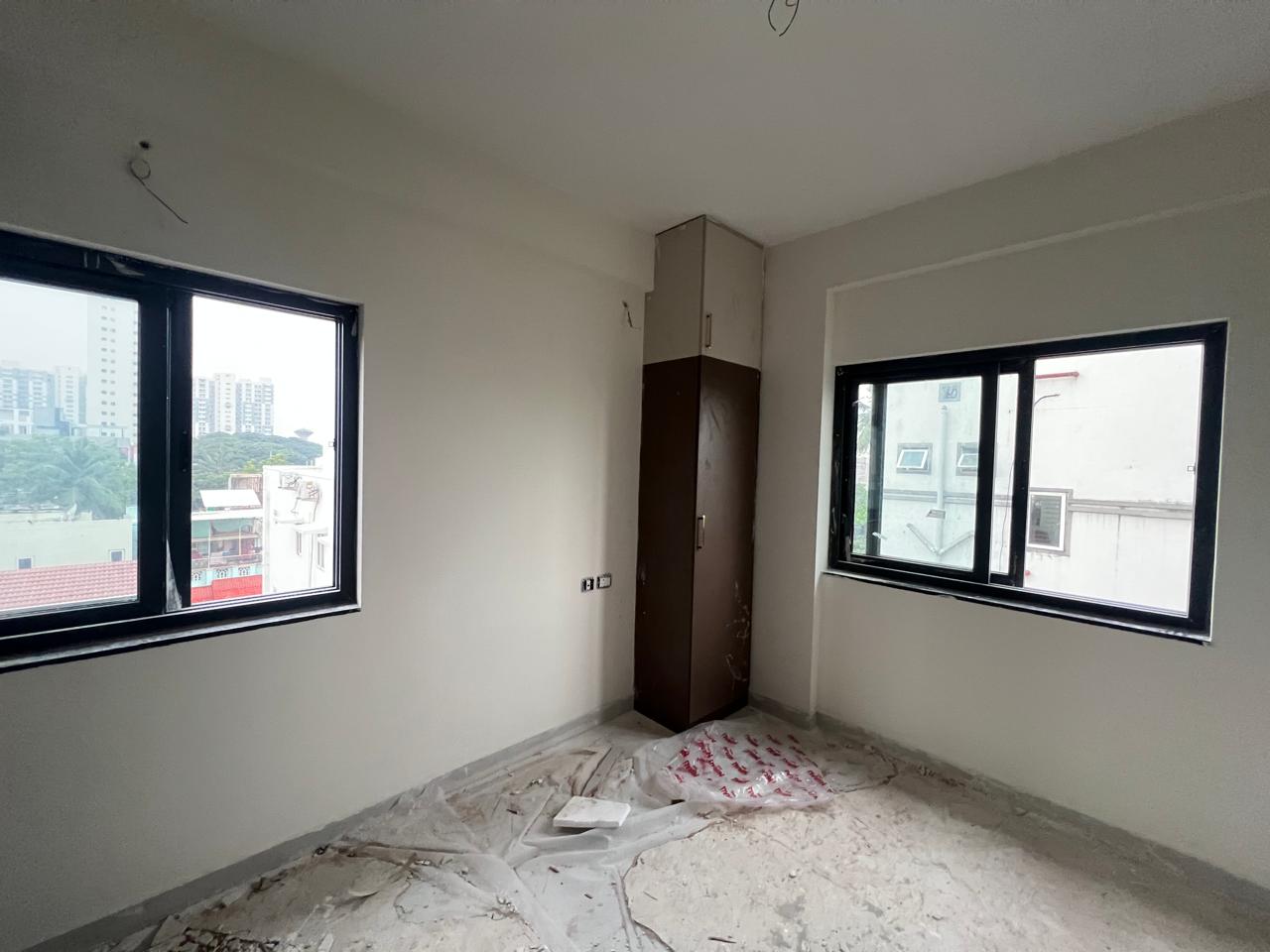

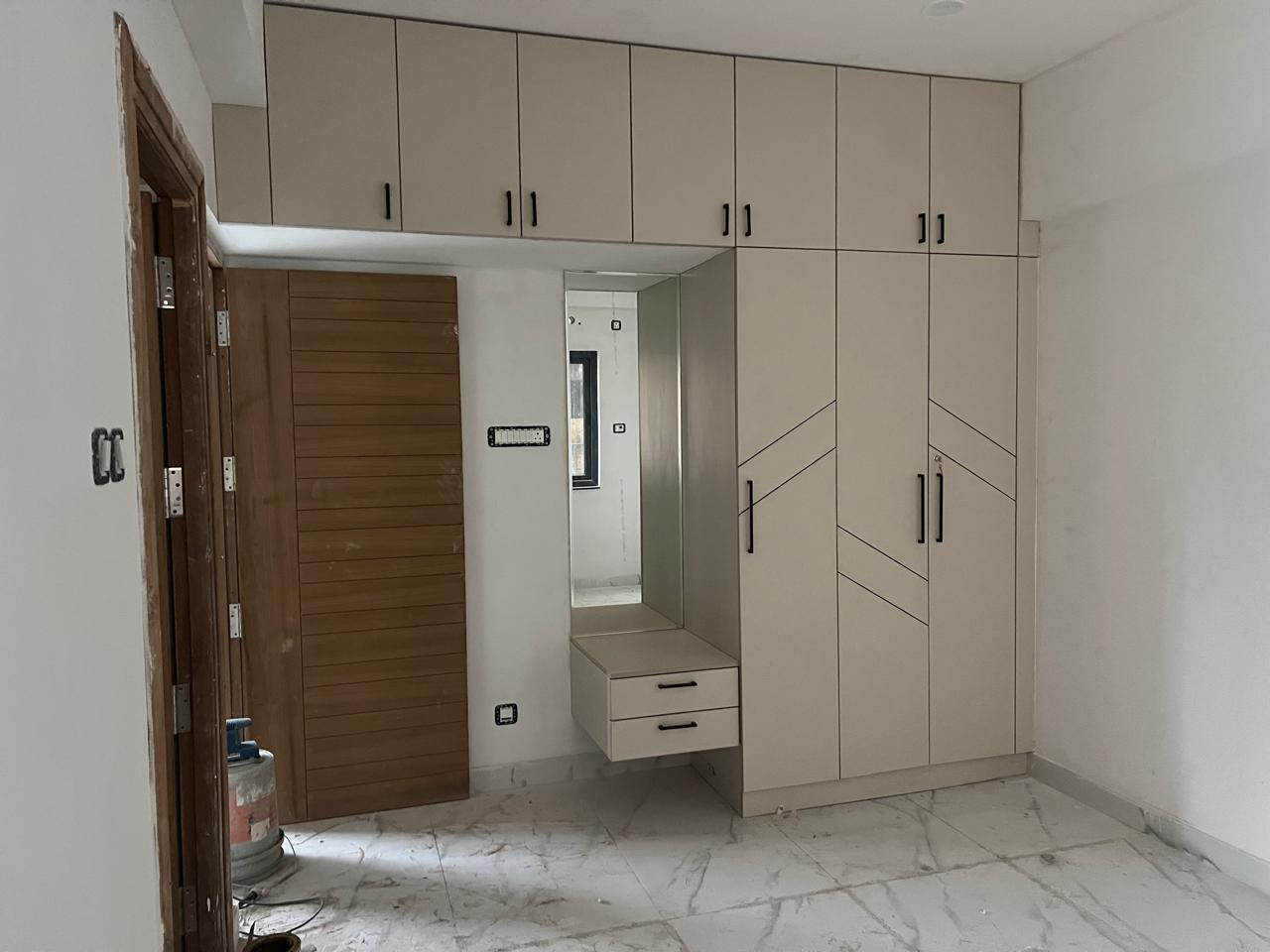

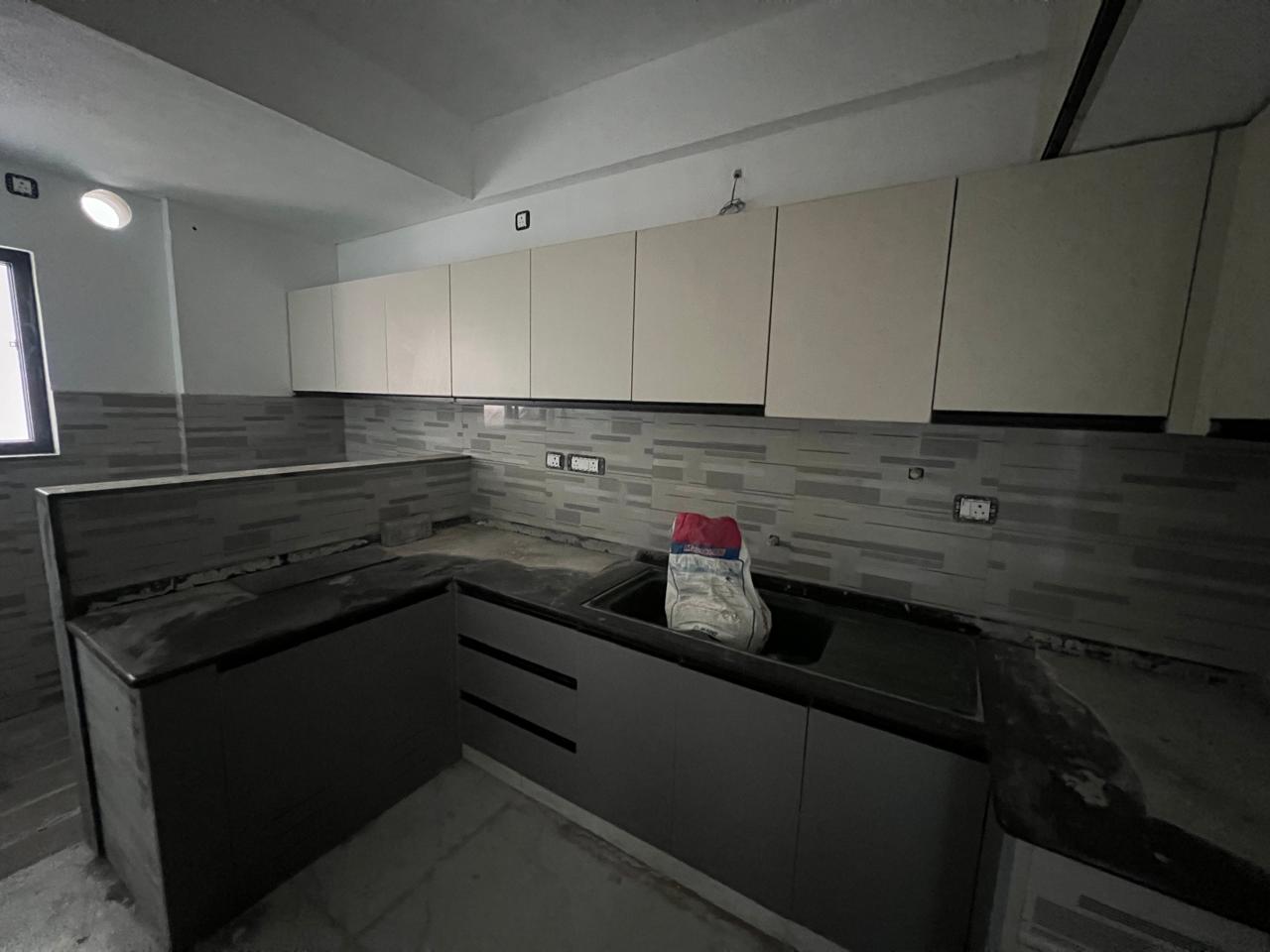

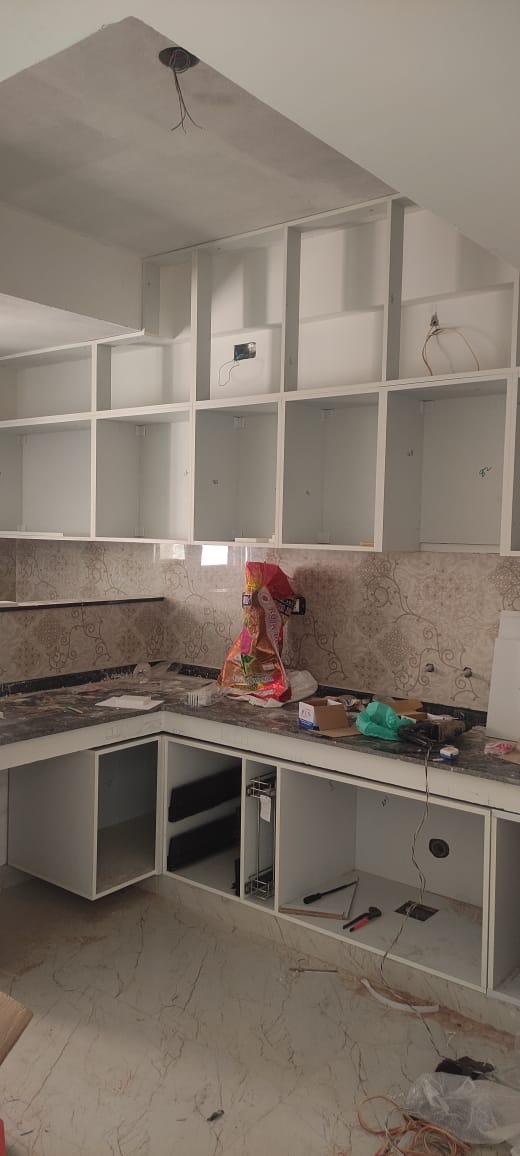

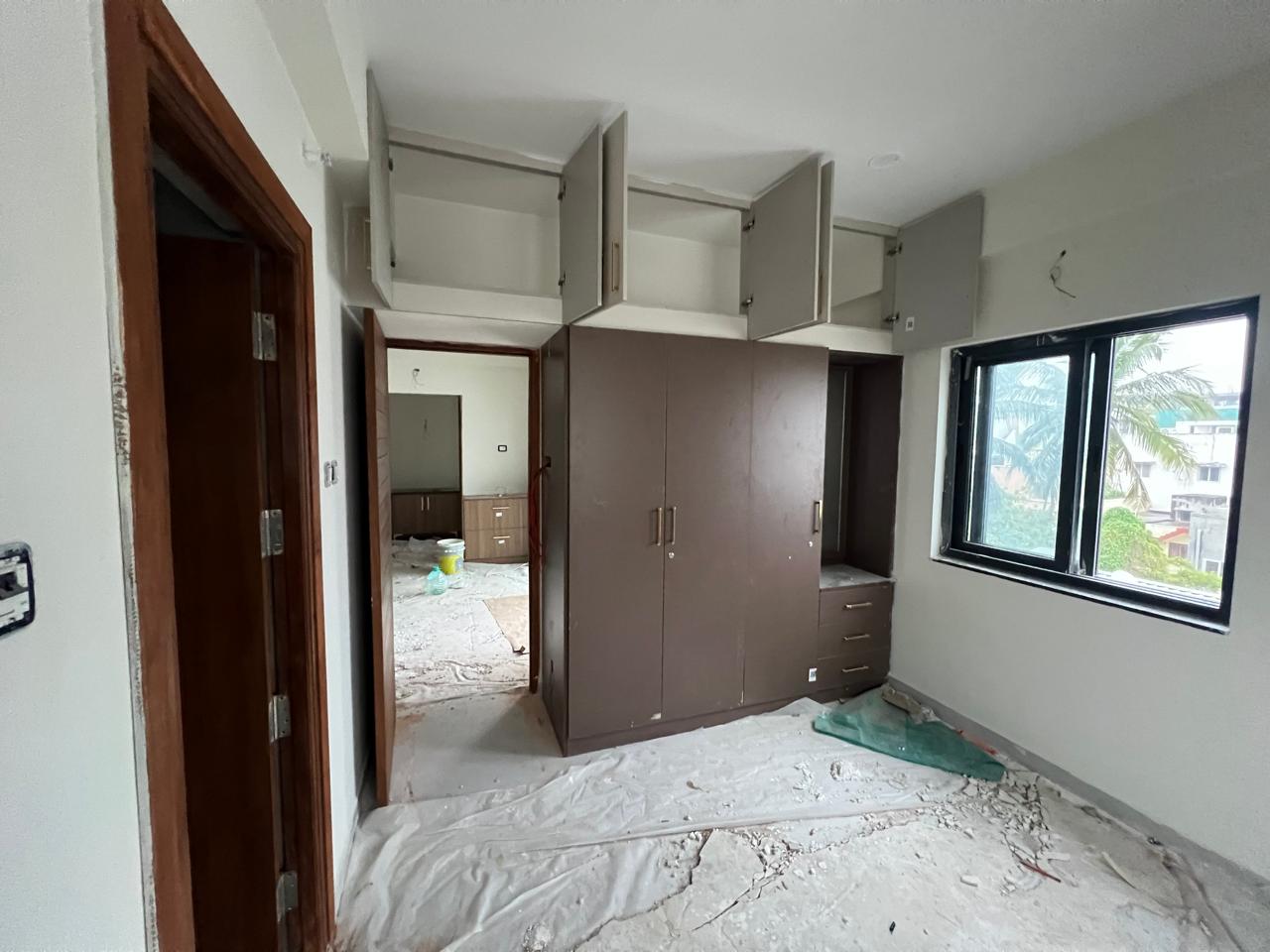

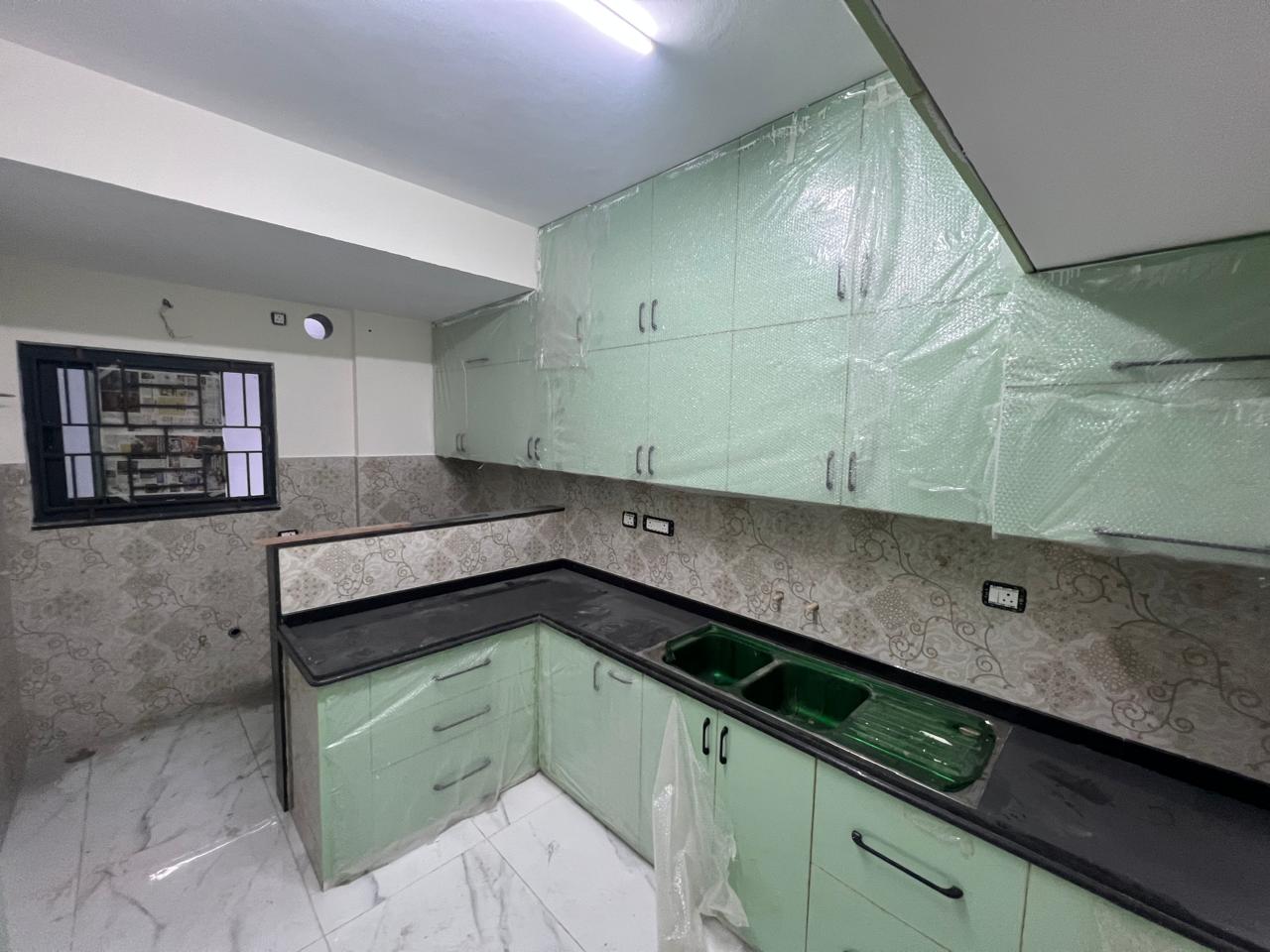

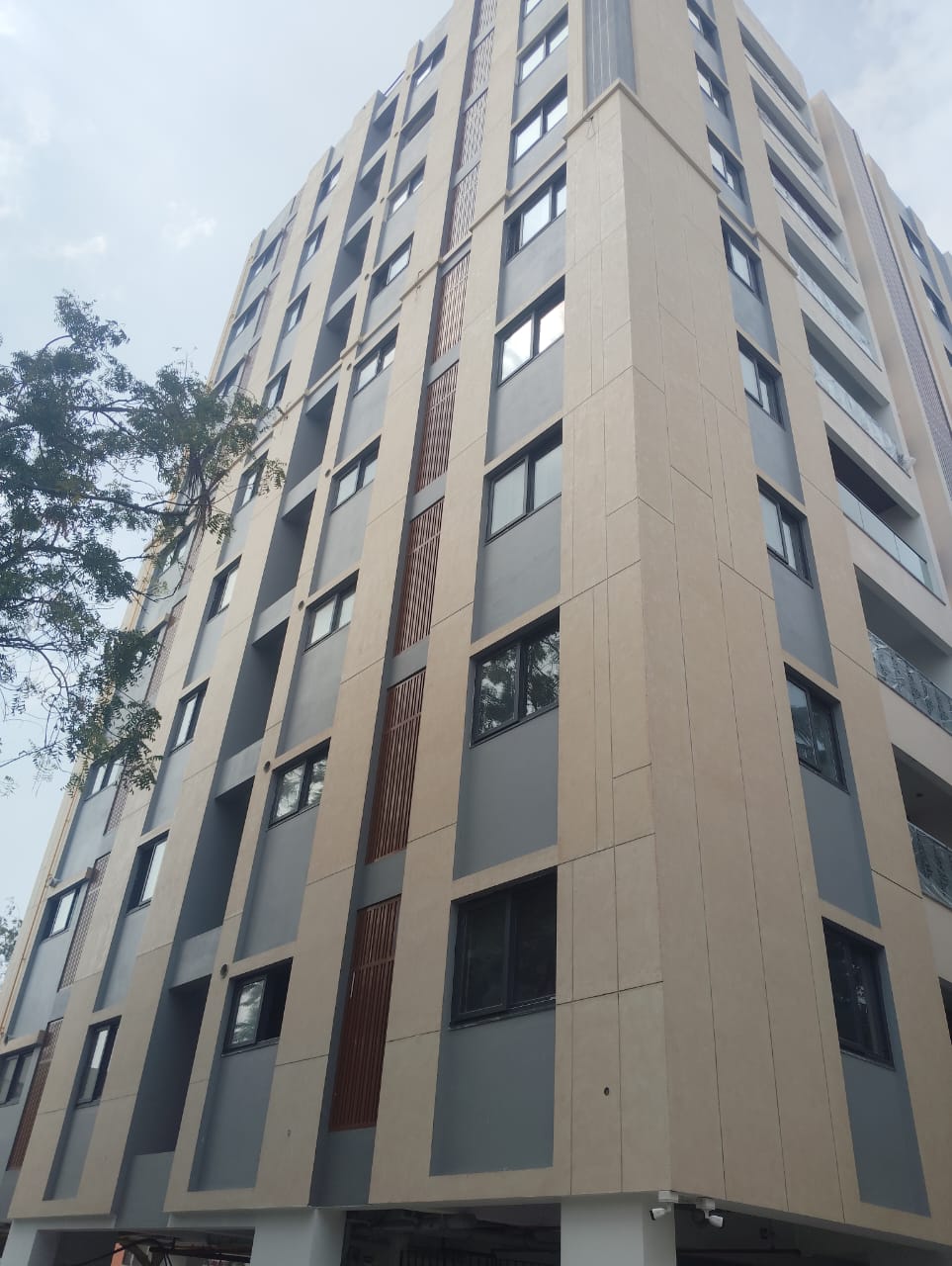

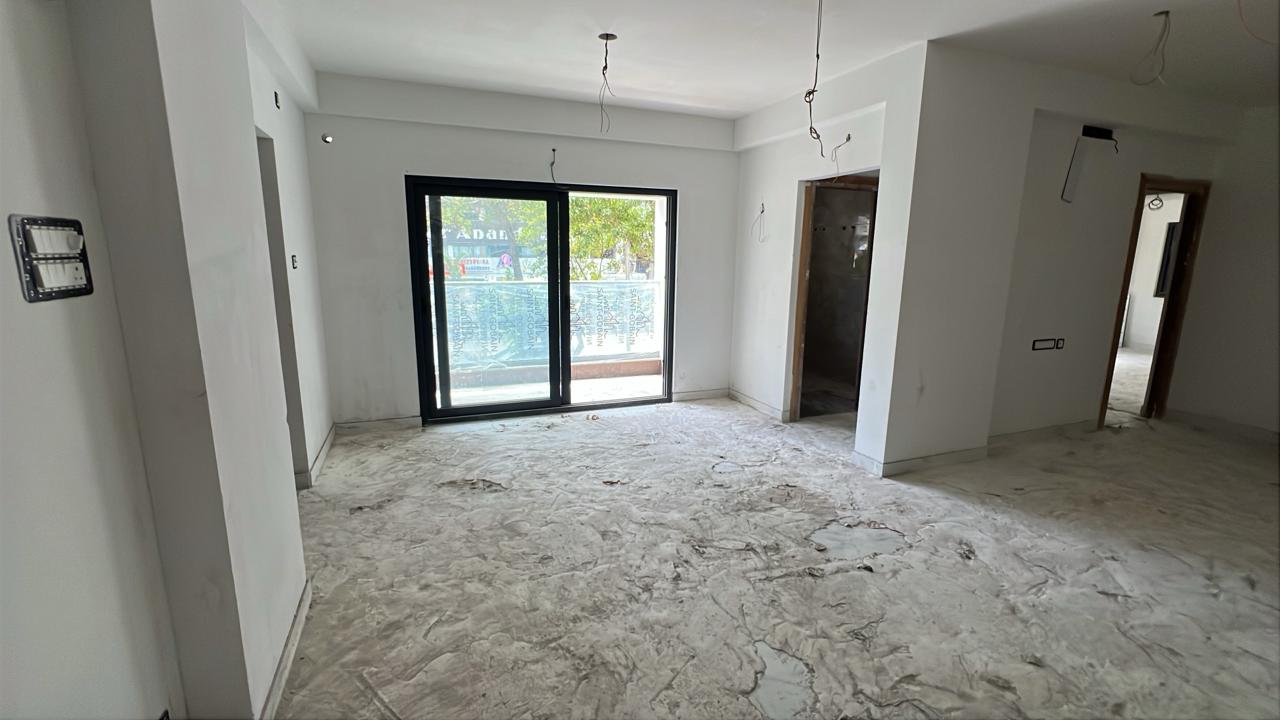

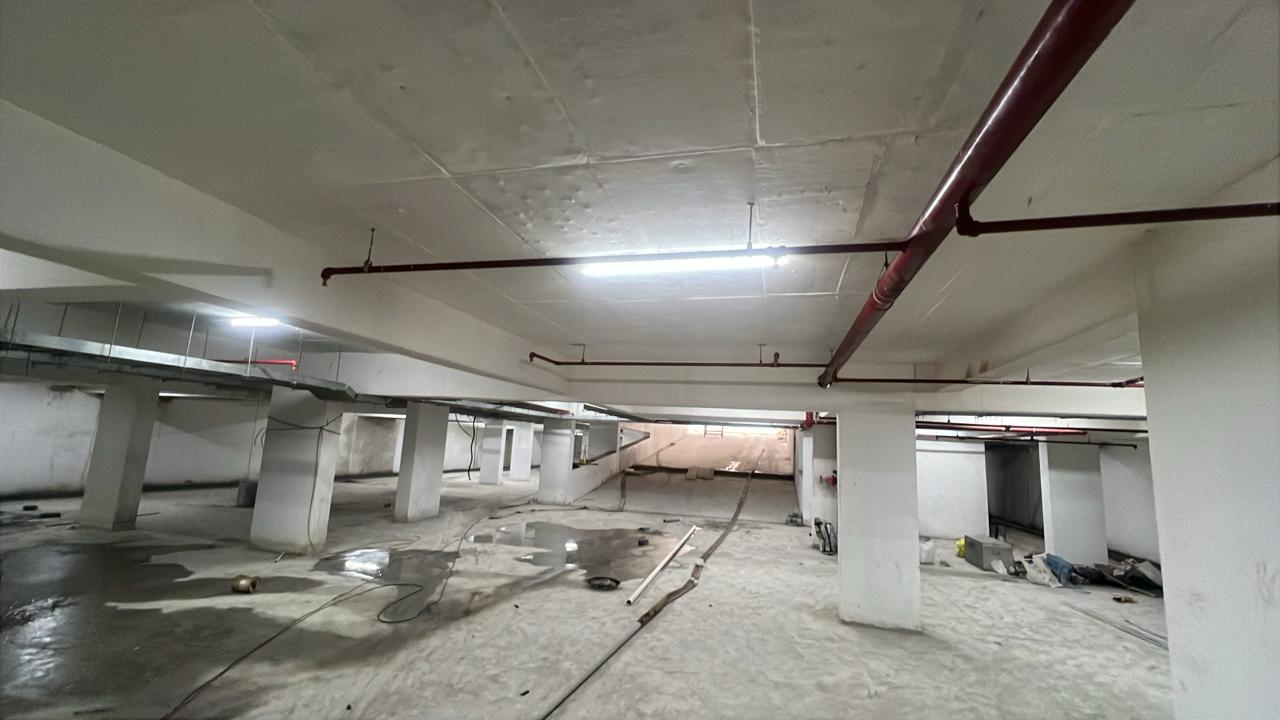

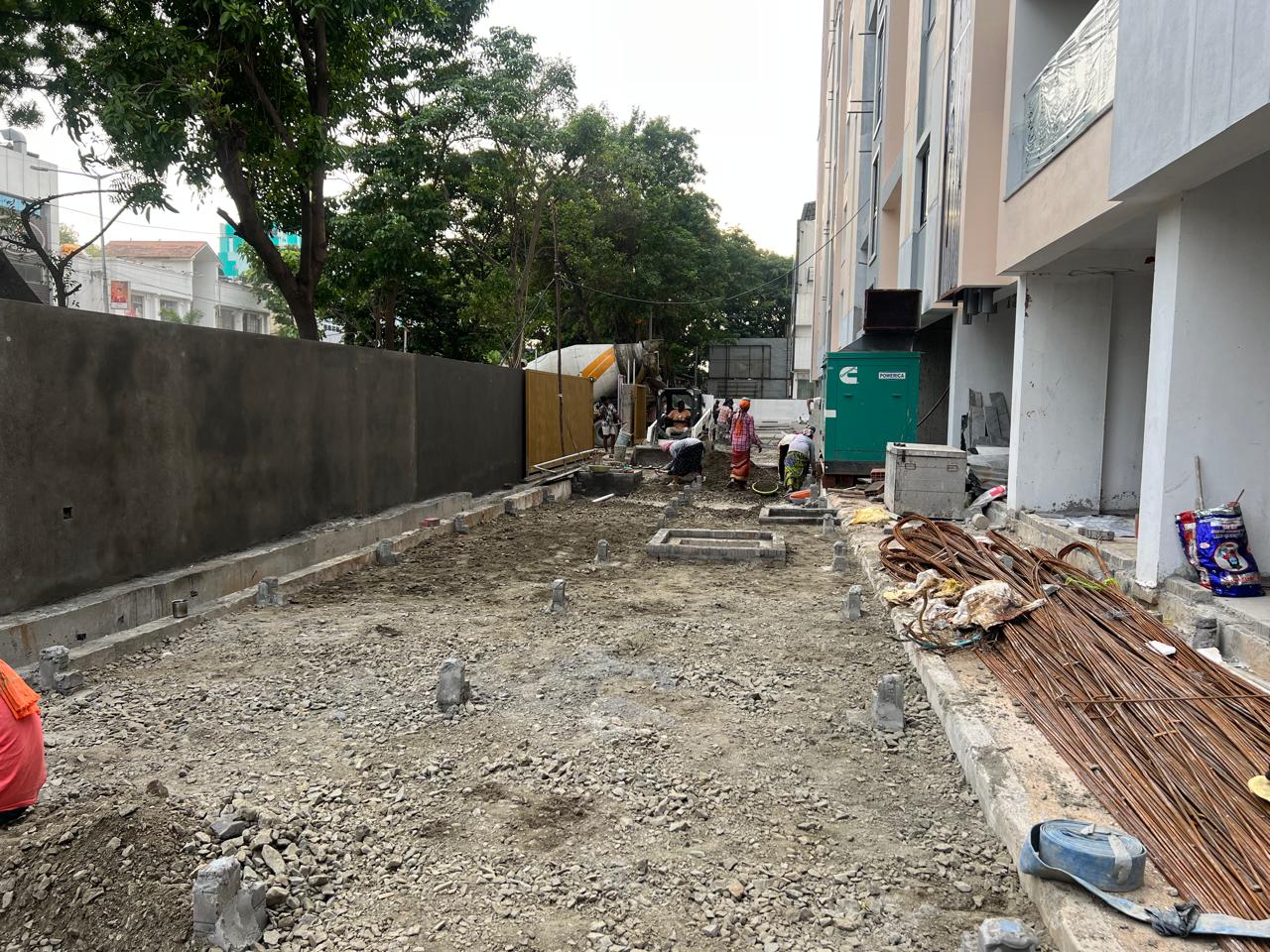

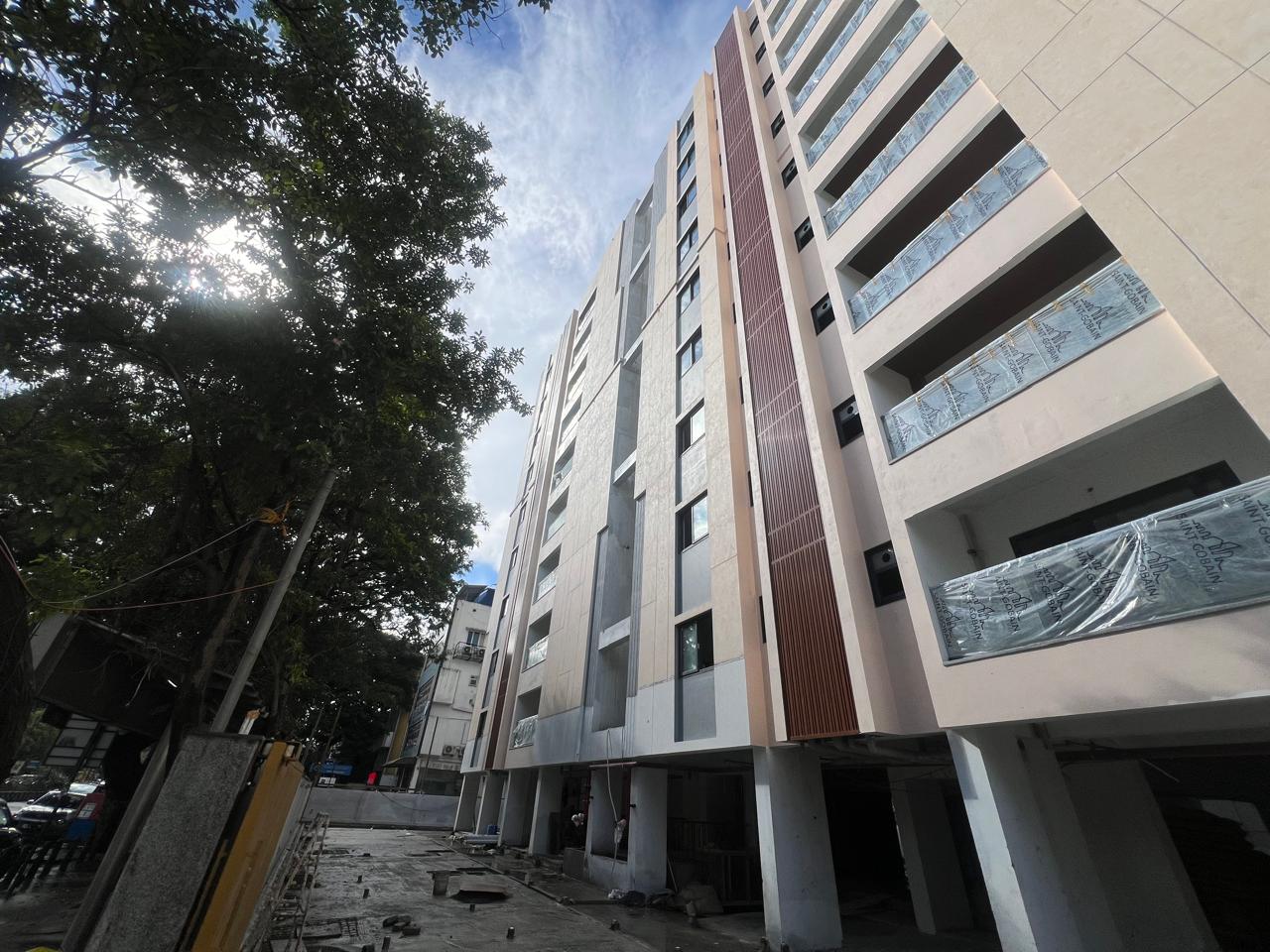

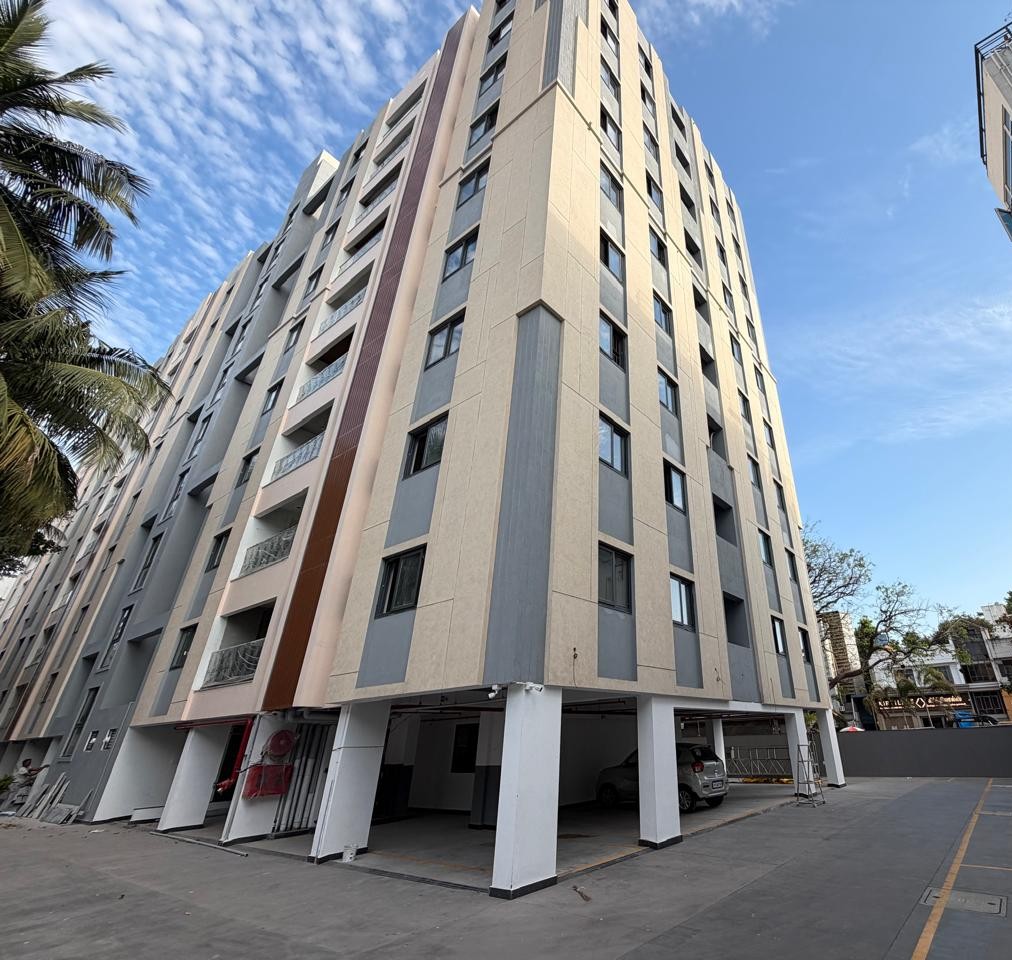

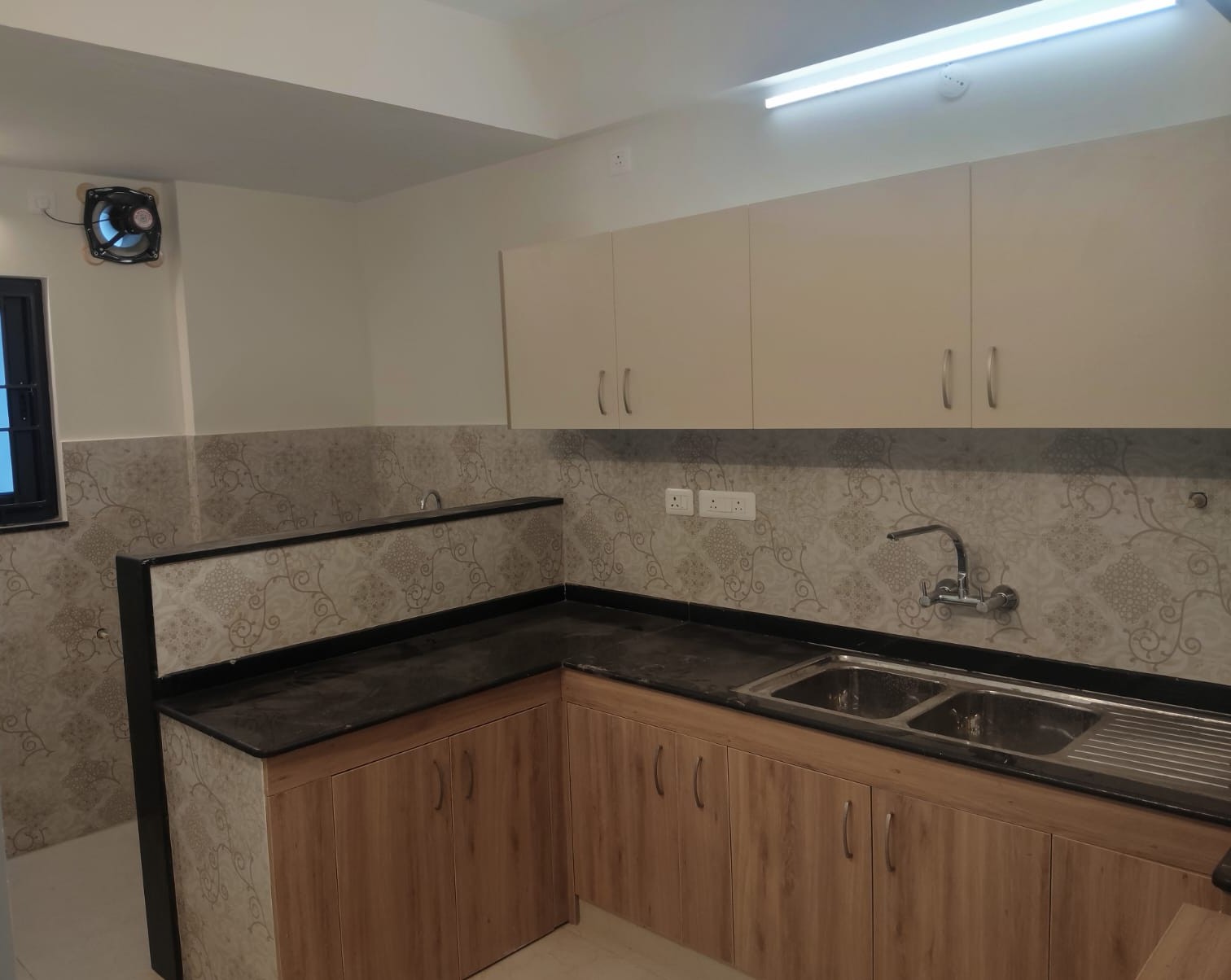

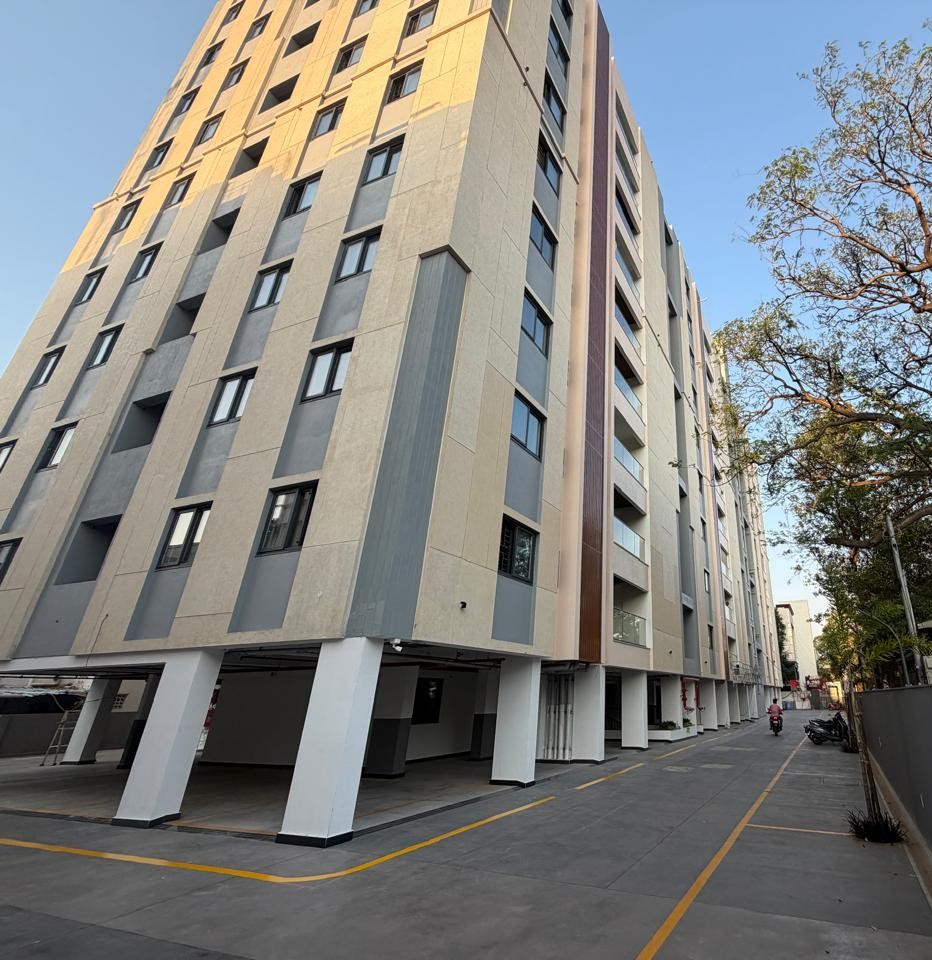

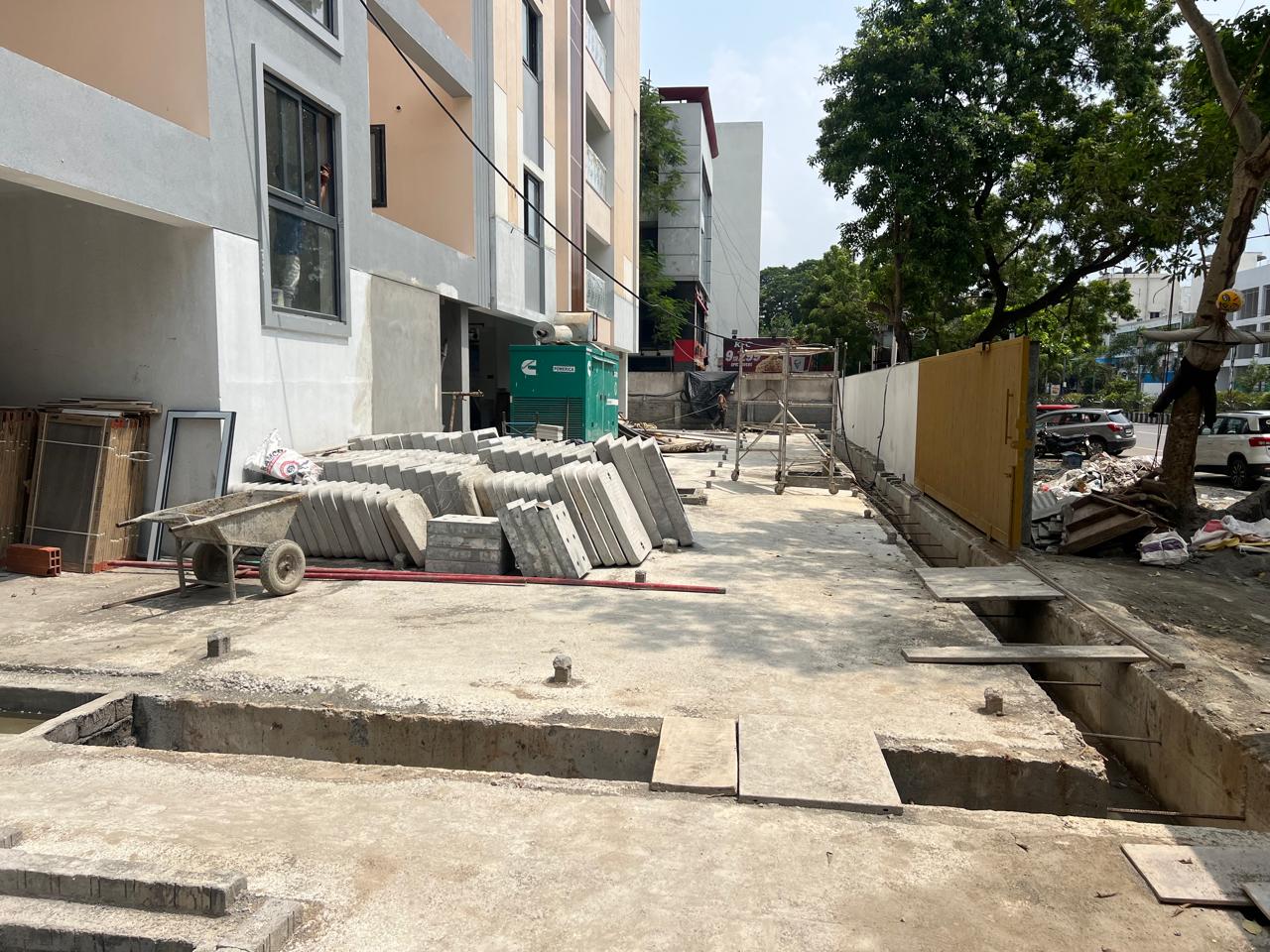

  • Wood work is in progress.(upto 5th floor ).
  • Inner primer work is in progress. (upto 9th floor)
  • 9th floor plastering work is in progress.(80% completed)

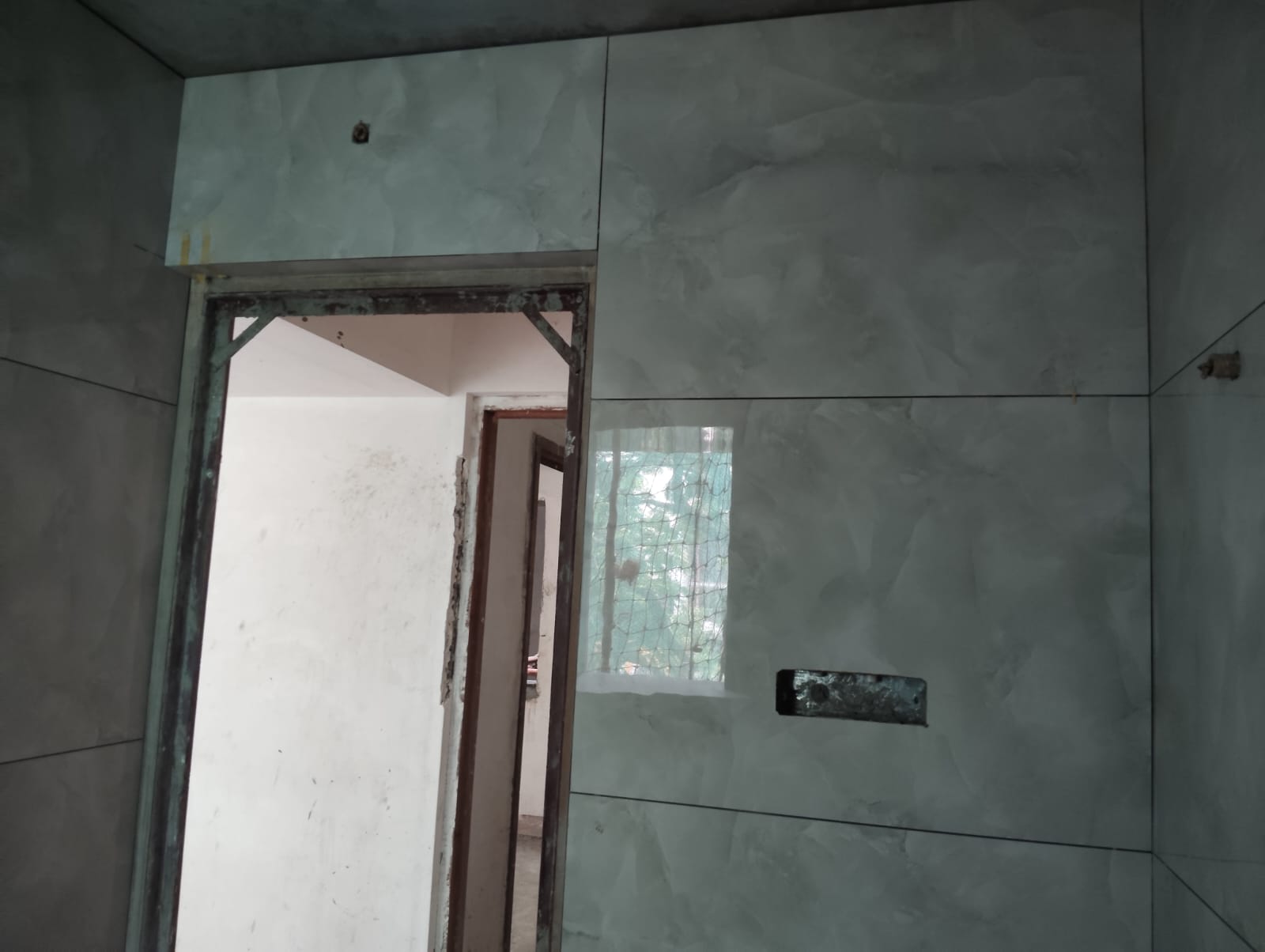

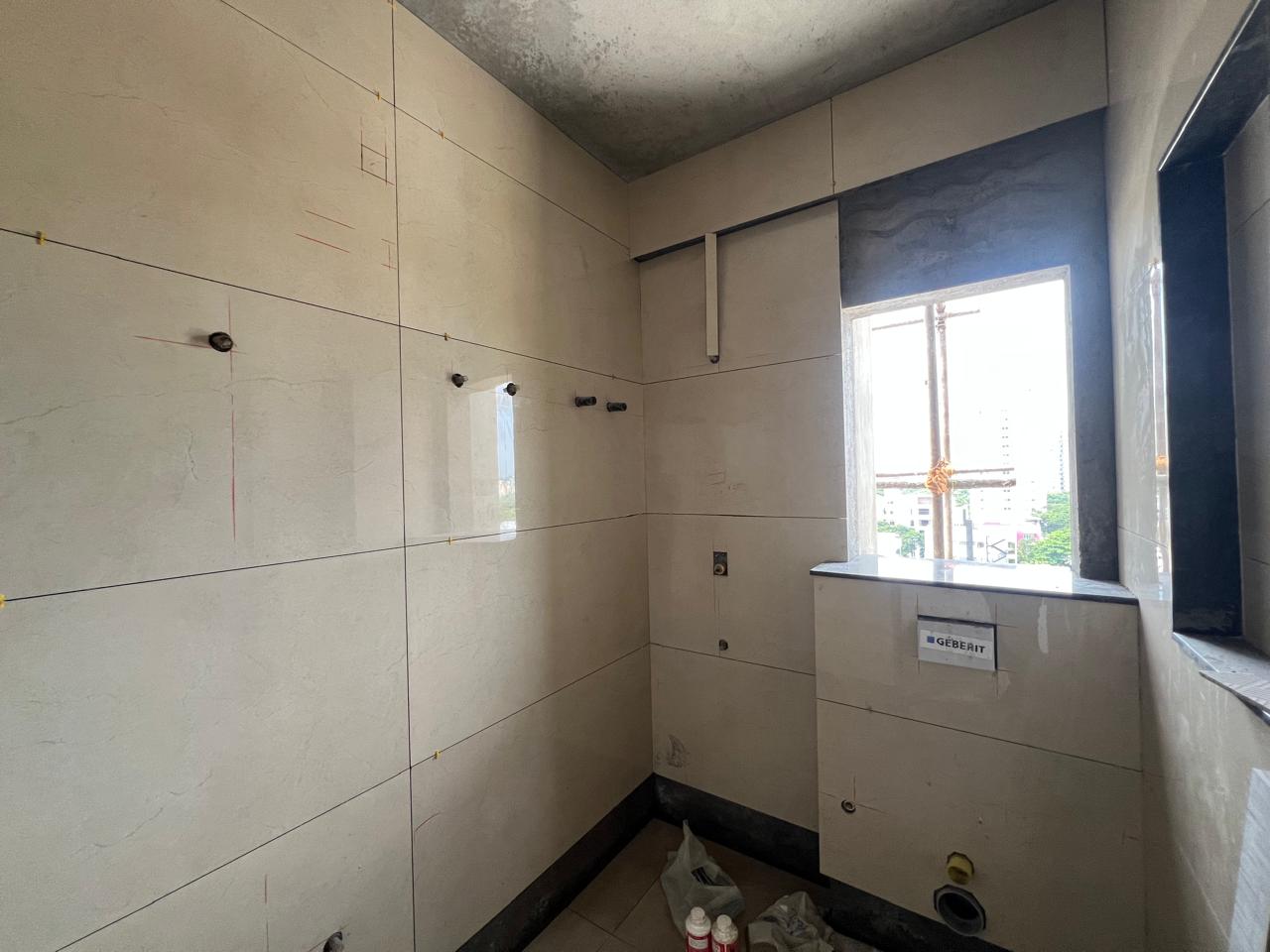

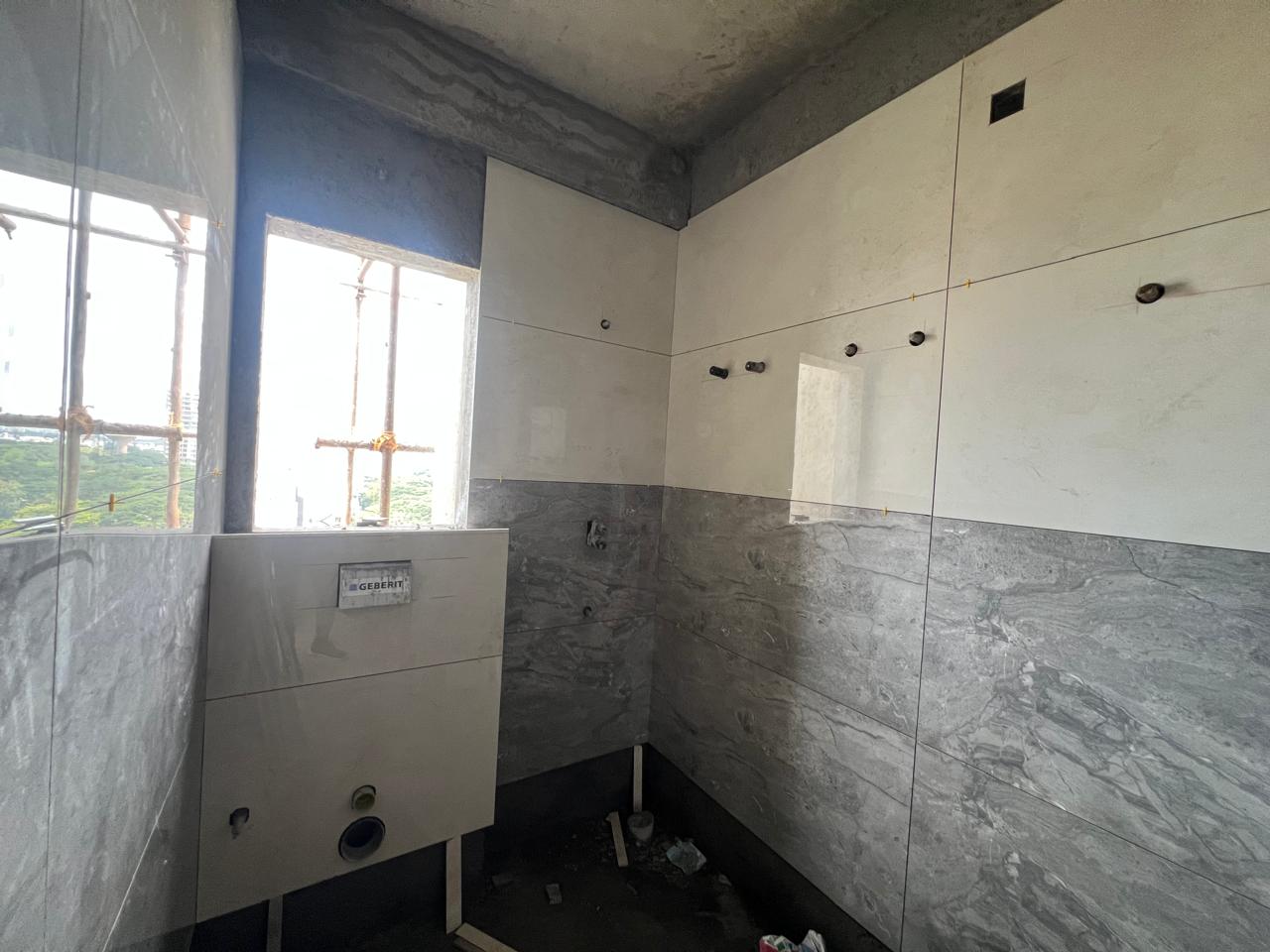

  • Toilet wall tiles work is in progress.(upto 8th floor completed)

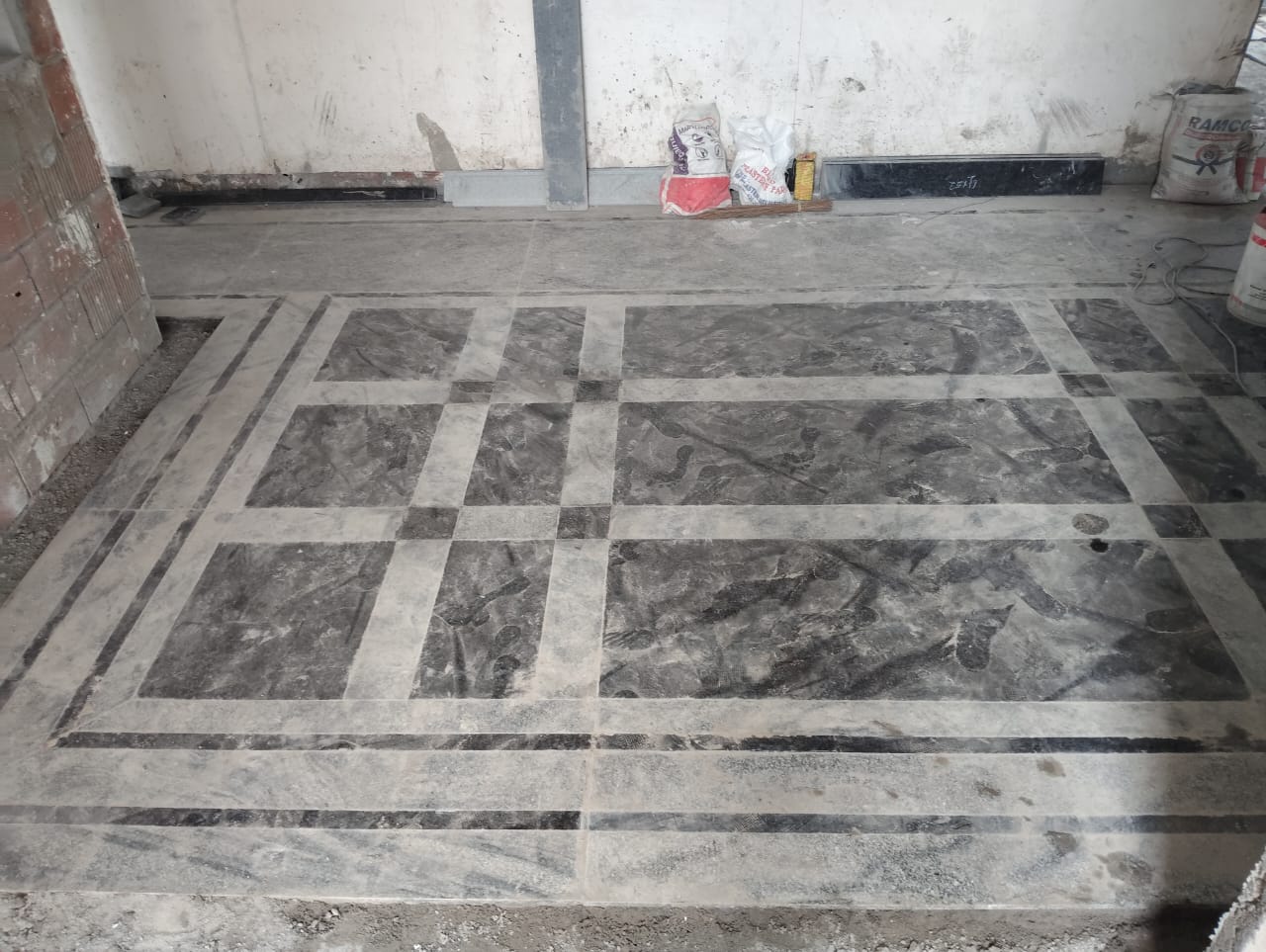

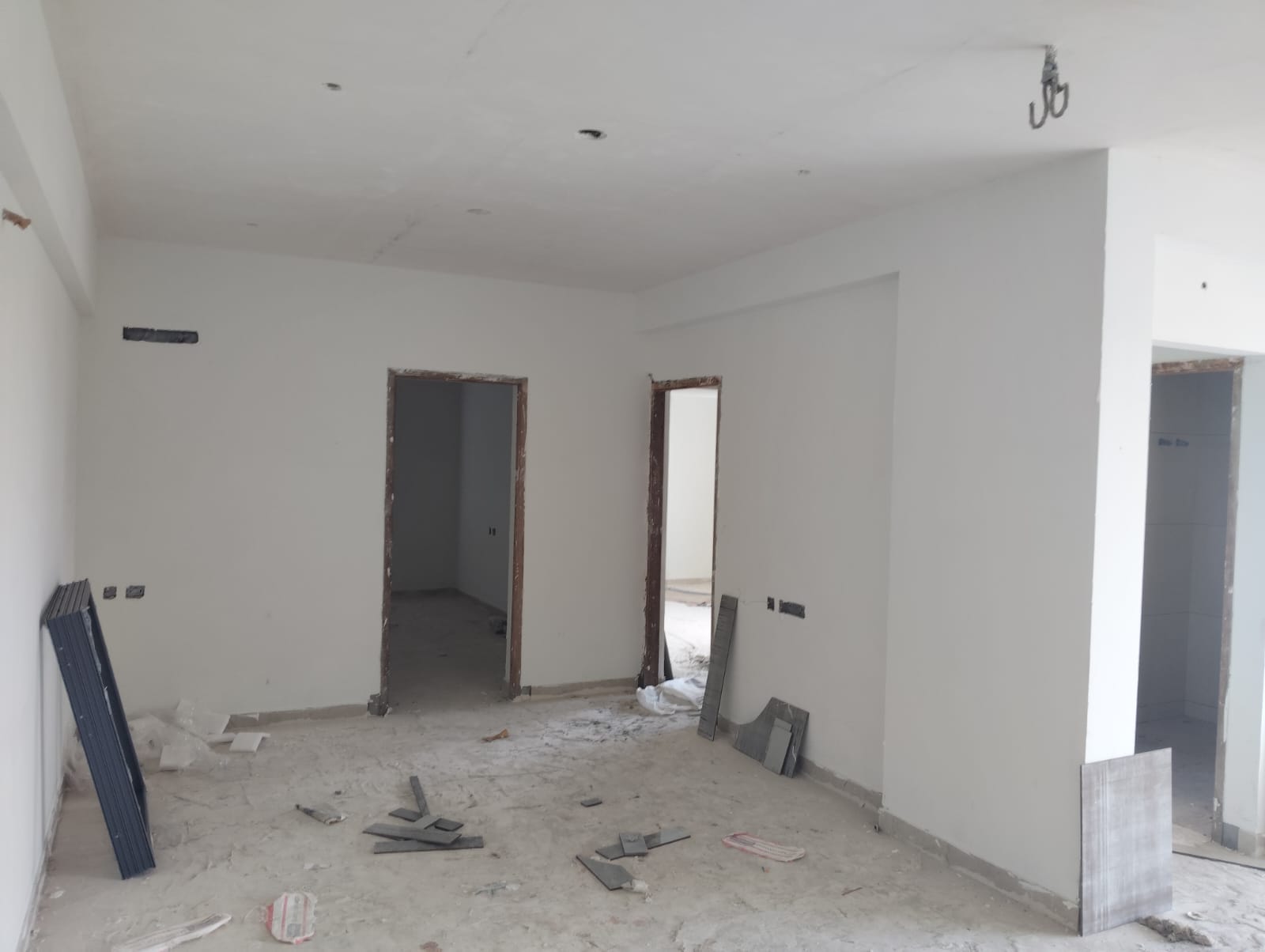

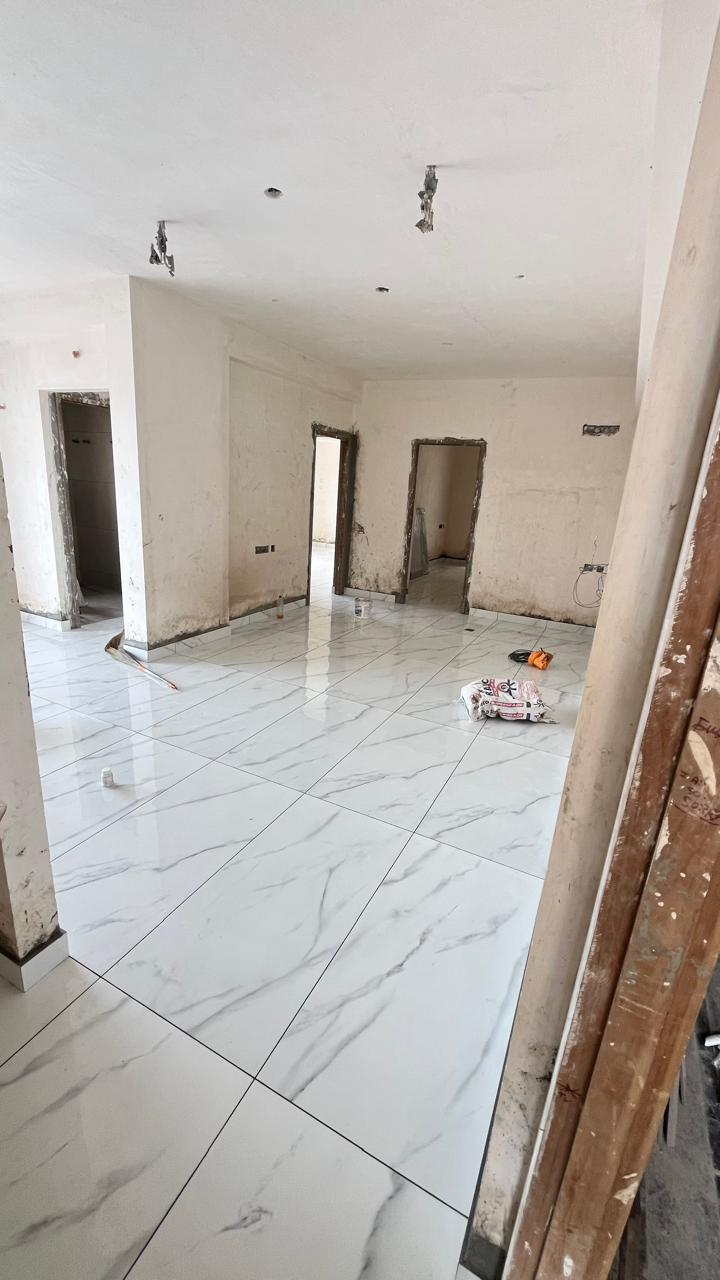

  • General flooring work is in progress.(upto 8th floor completed )
  • Toilet plumbing work is in progress.(upto 9th floor )

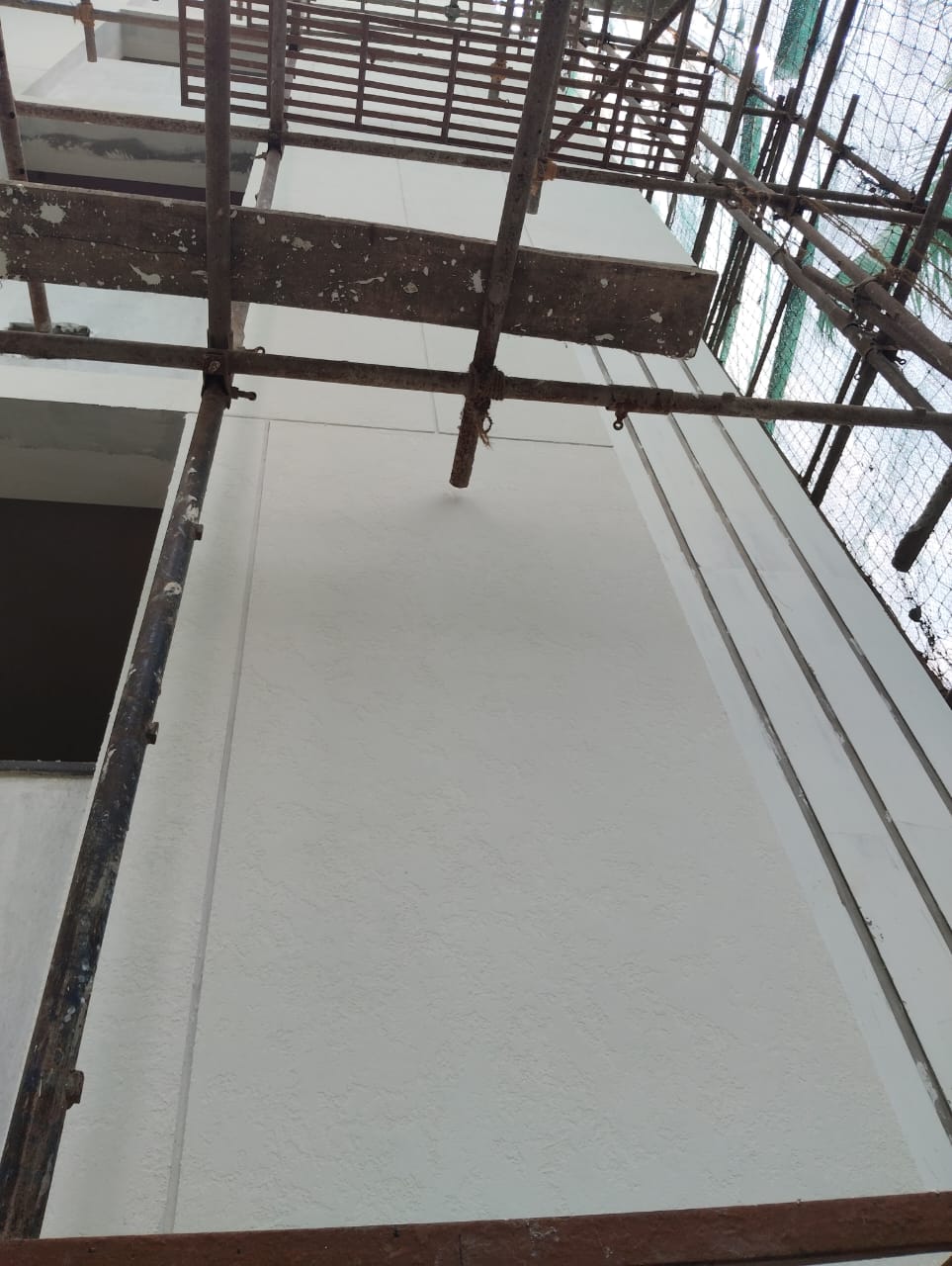

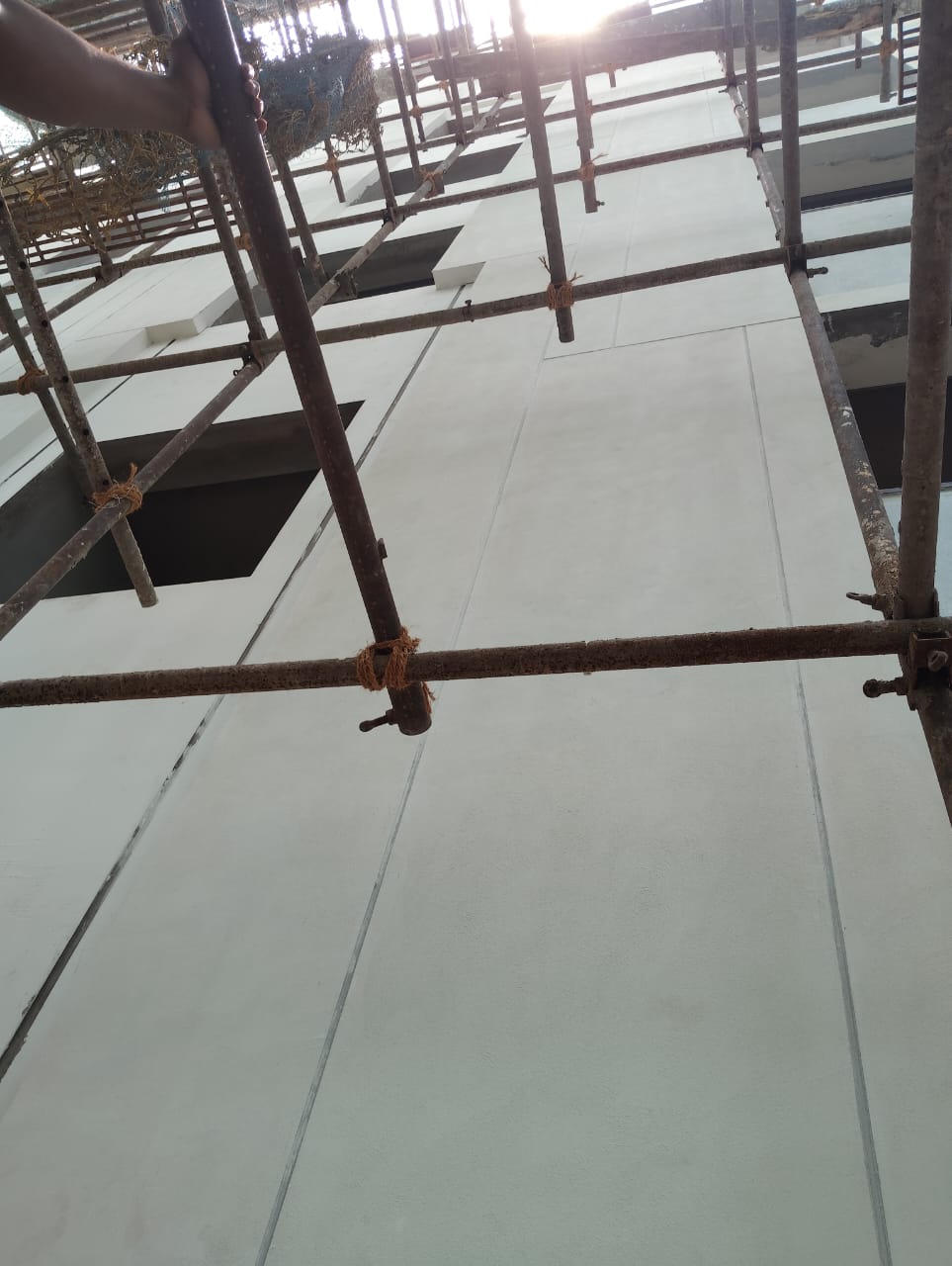

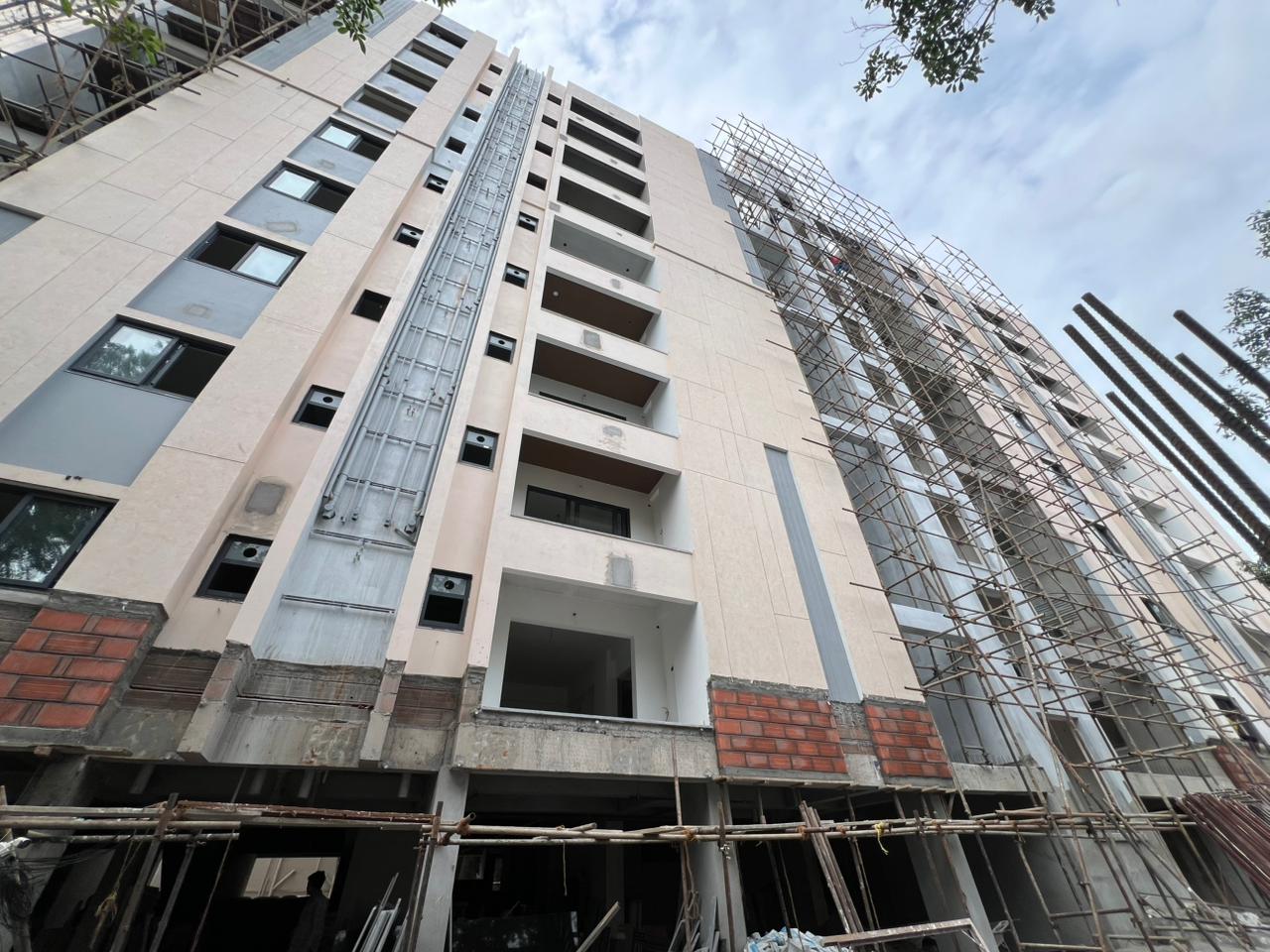

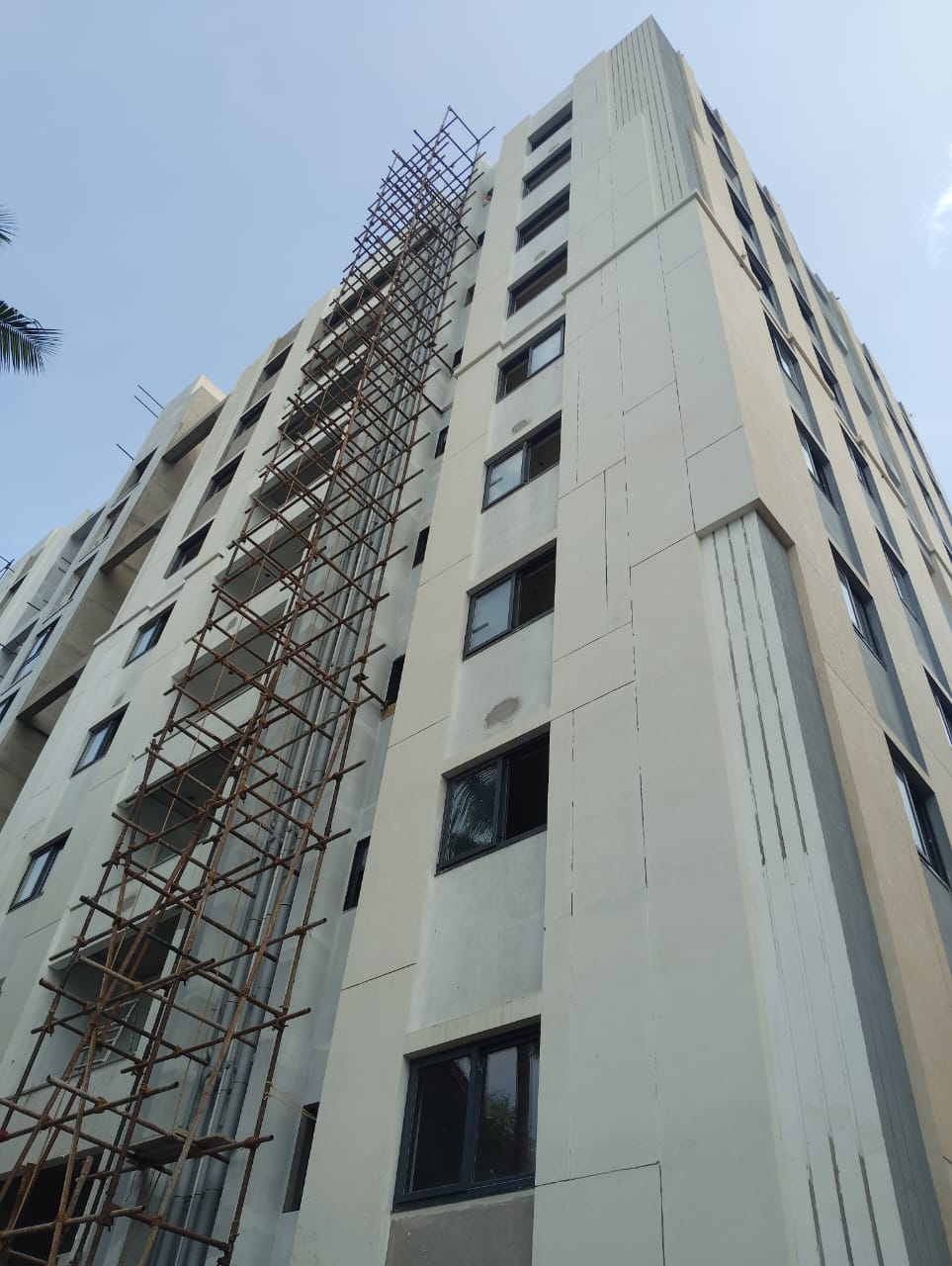

  • External texture work is in progress.(75% completed)

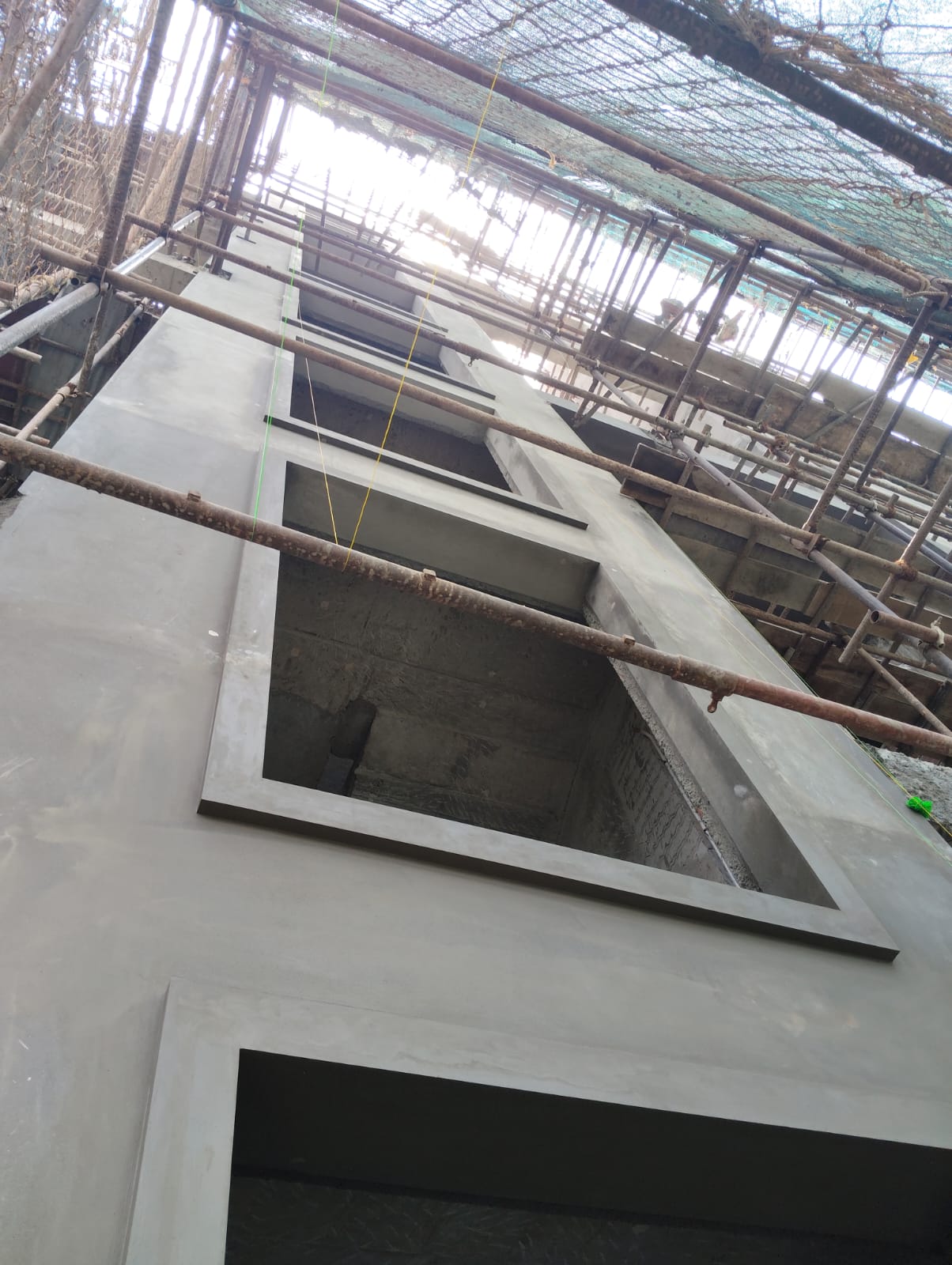

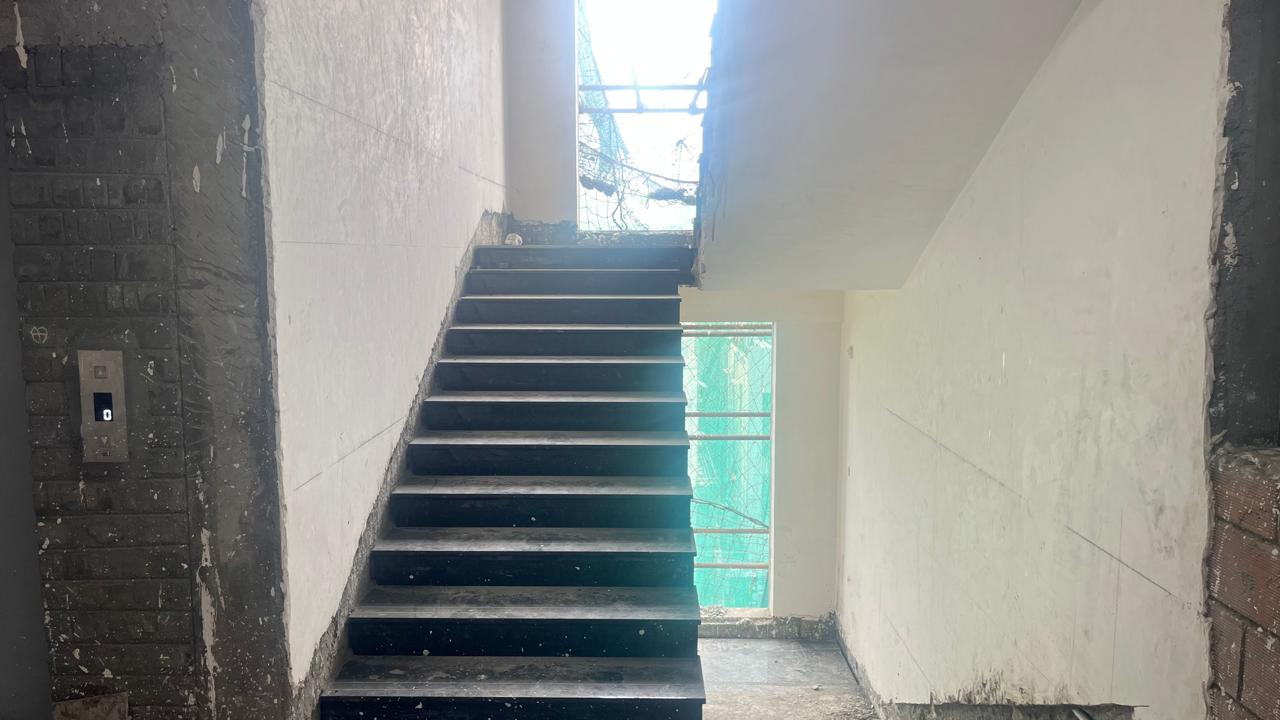

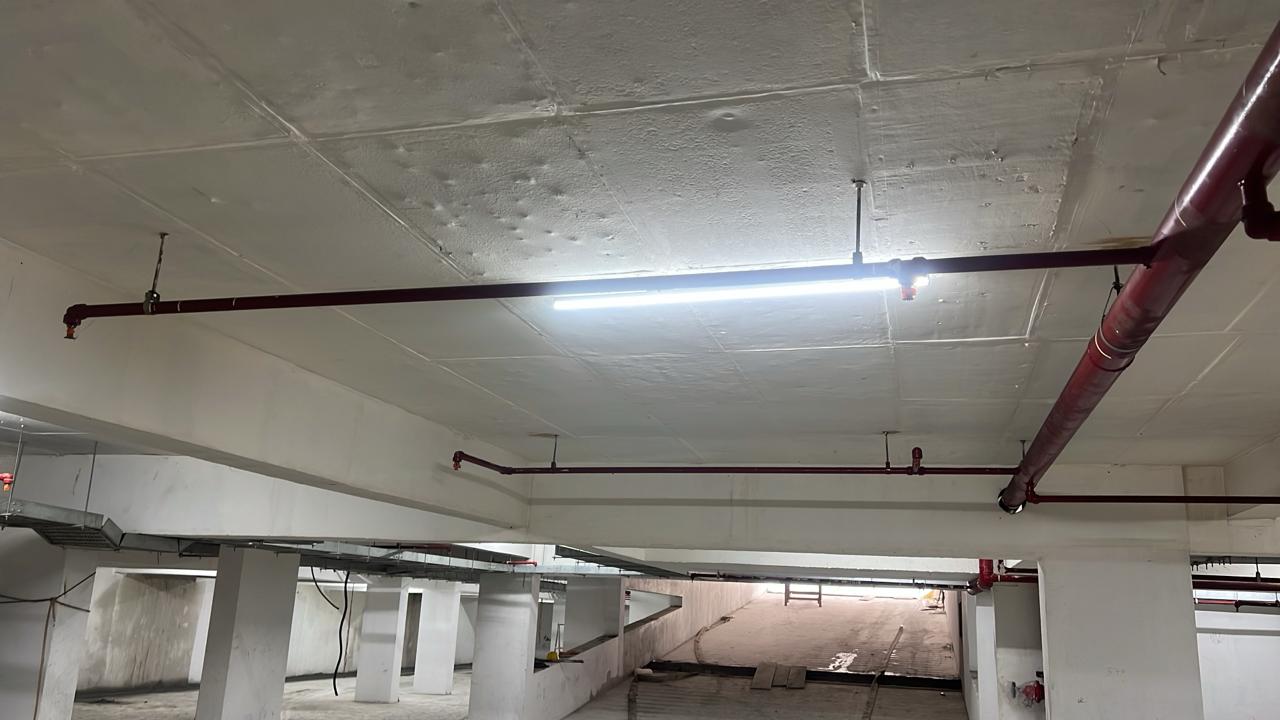

  • Lift erection work is in progress.
  • Lift wall cladding work is completed.
  • External stamping –pcc work is completed.

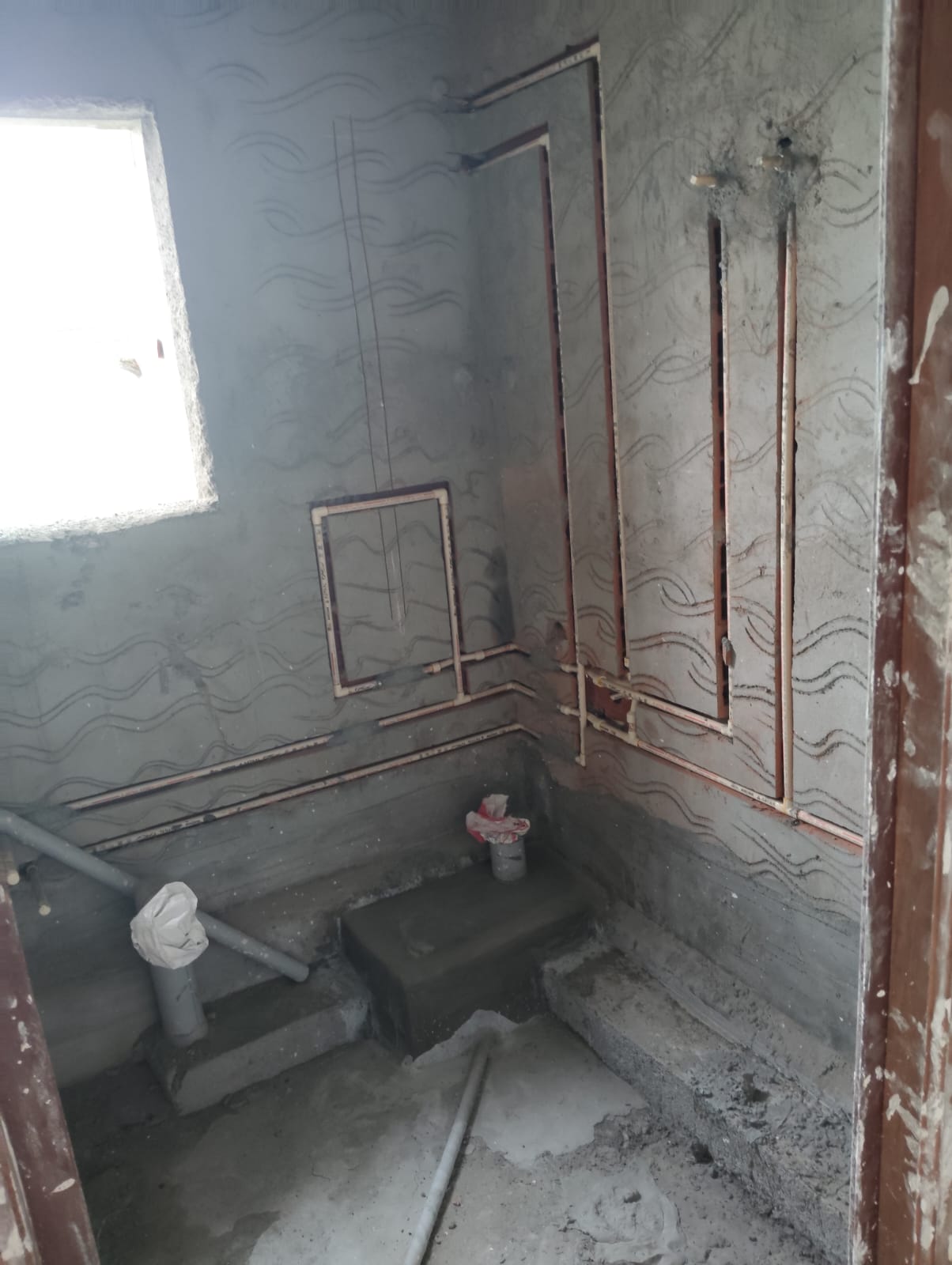

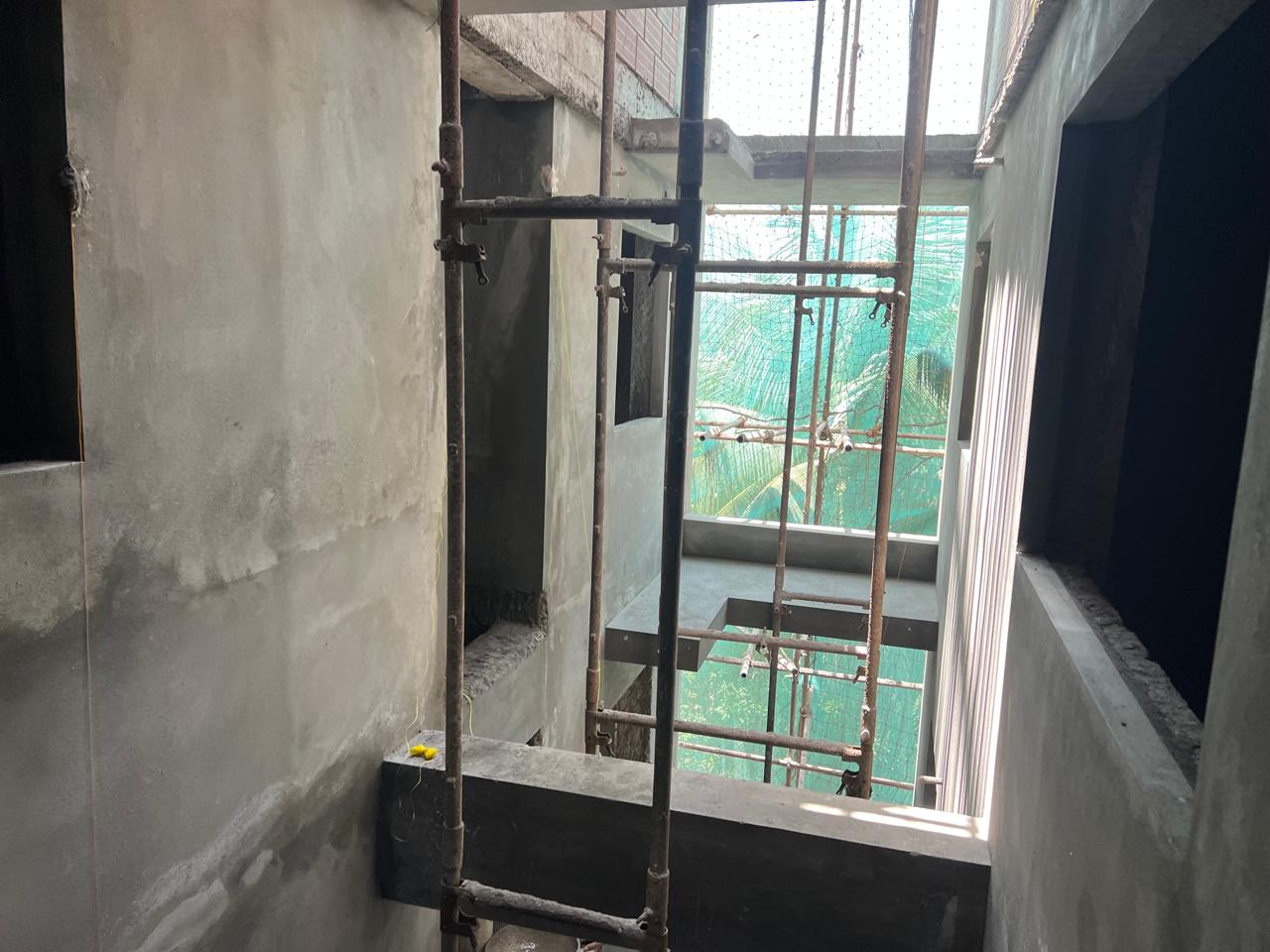

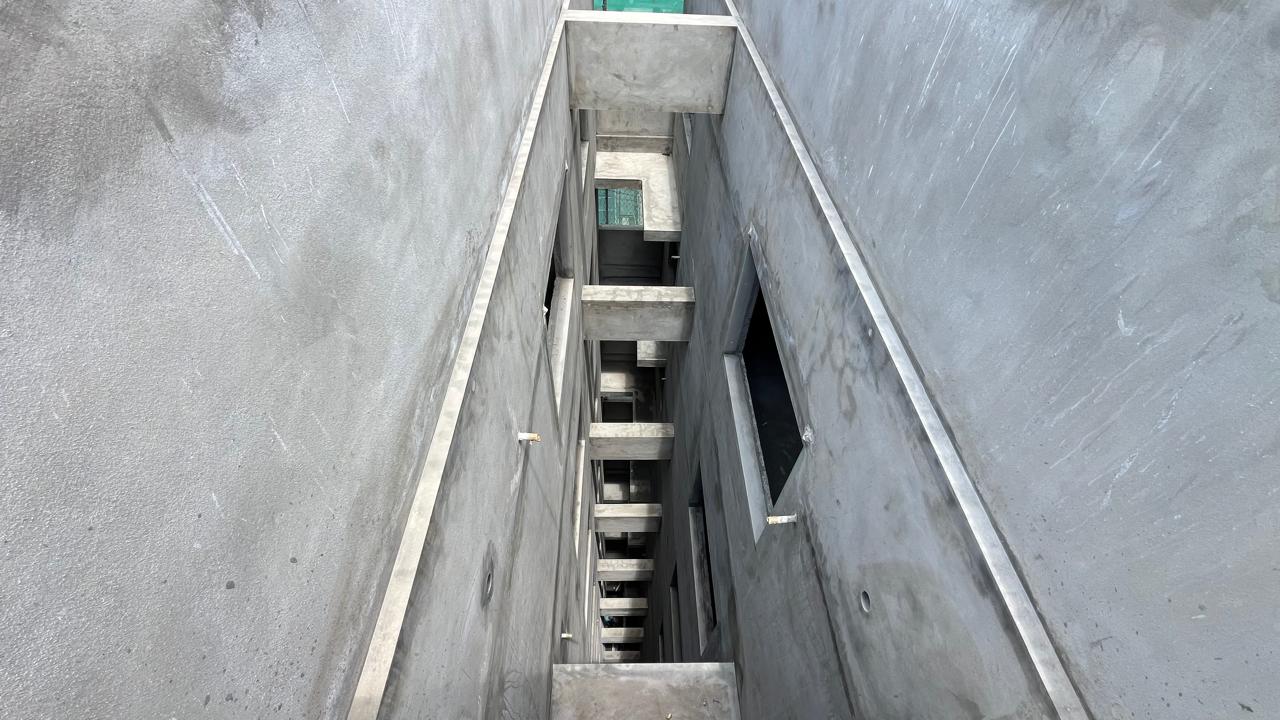

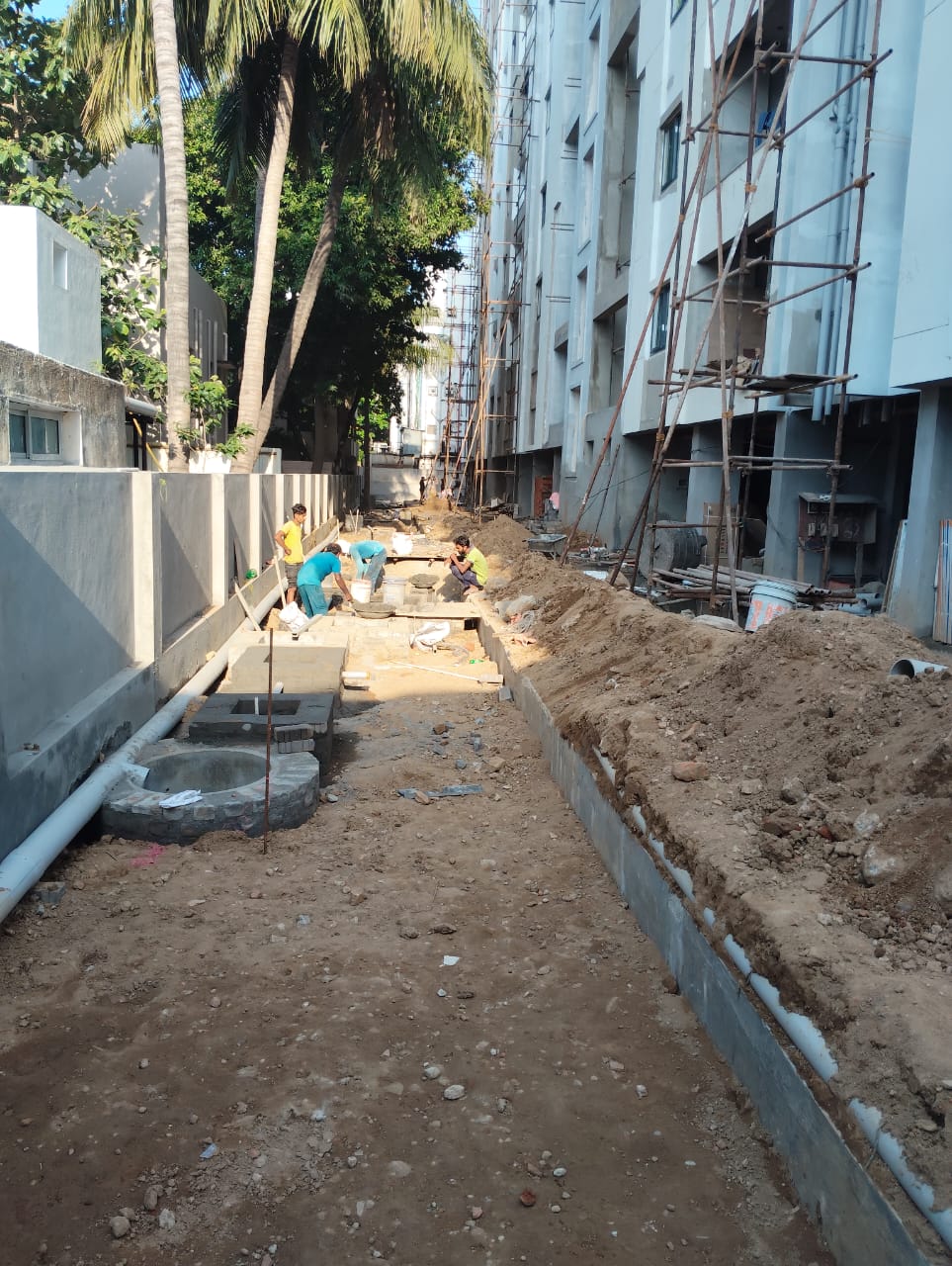

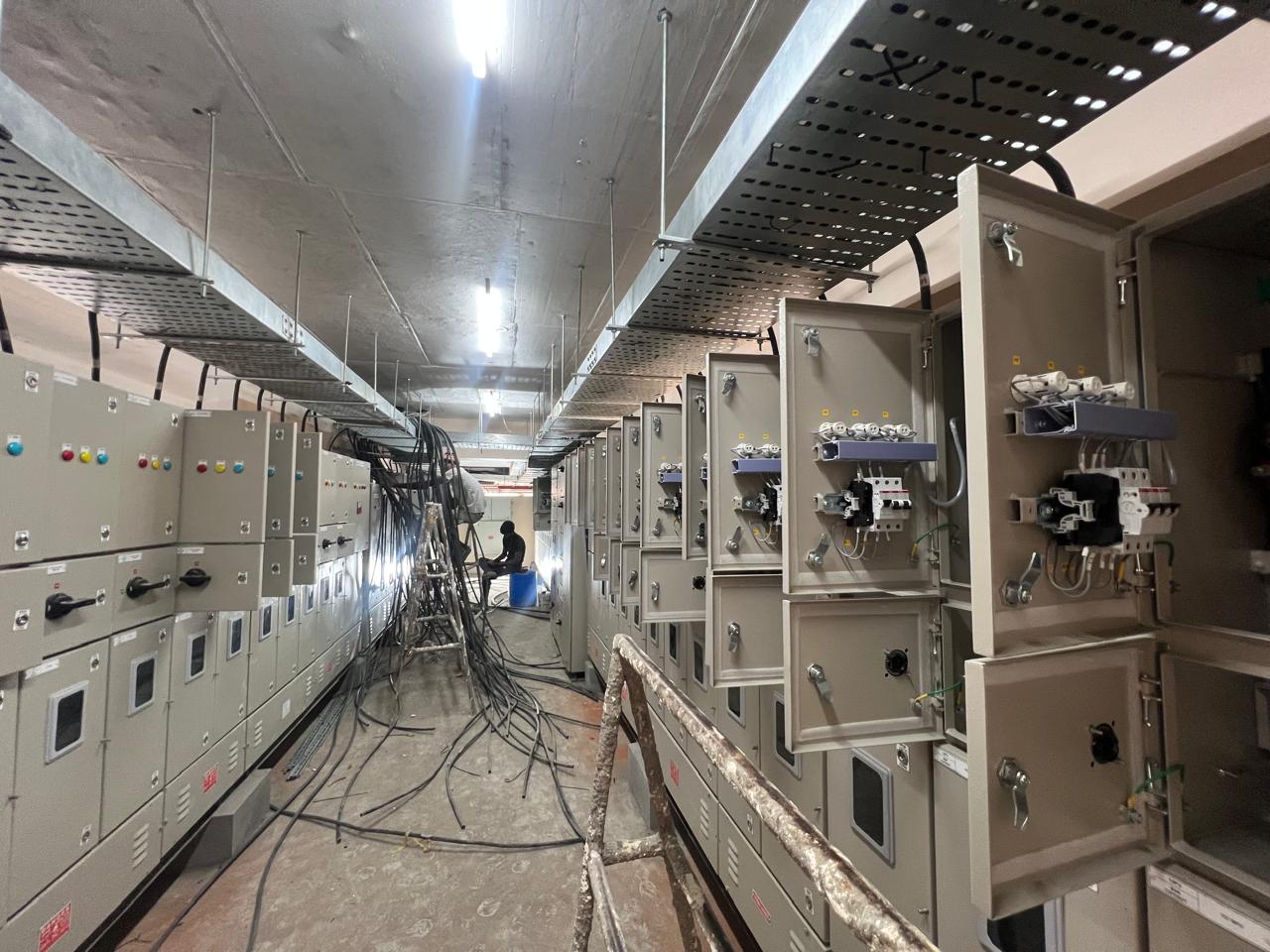

  • Duct plumbing work is in progress.

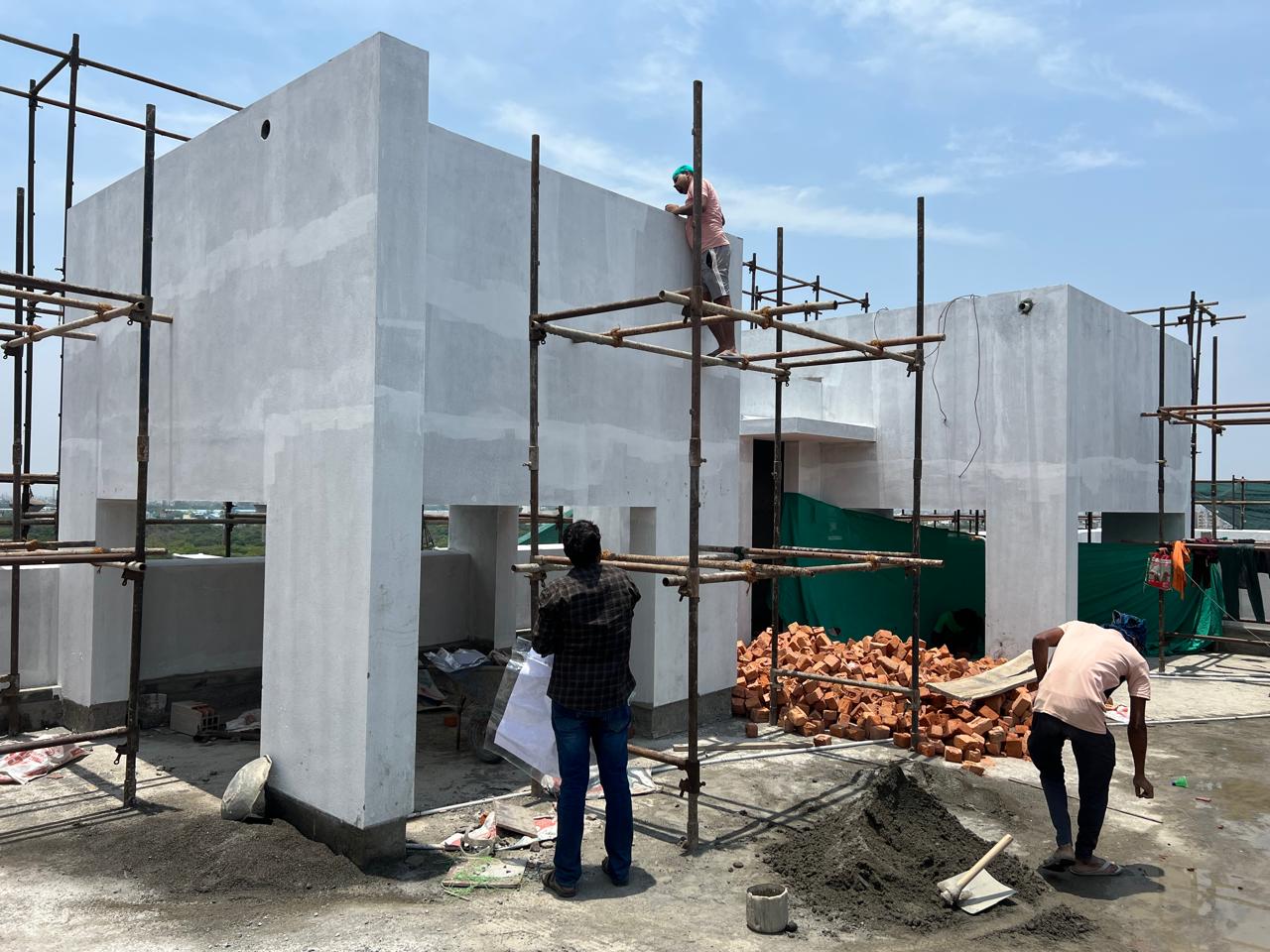

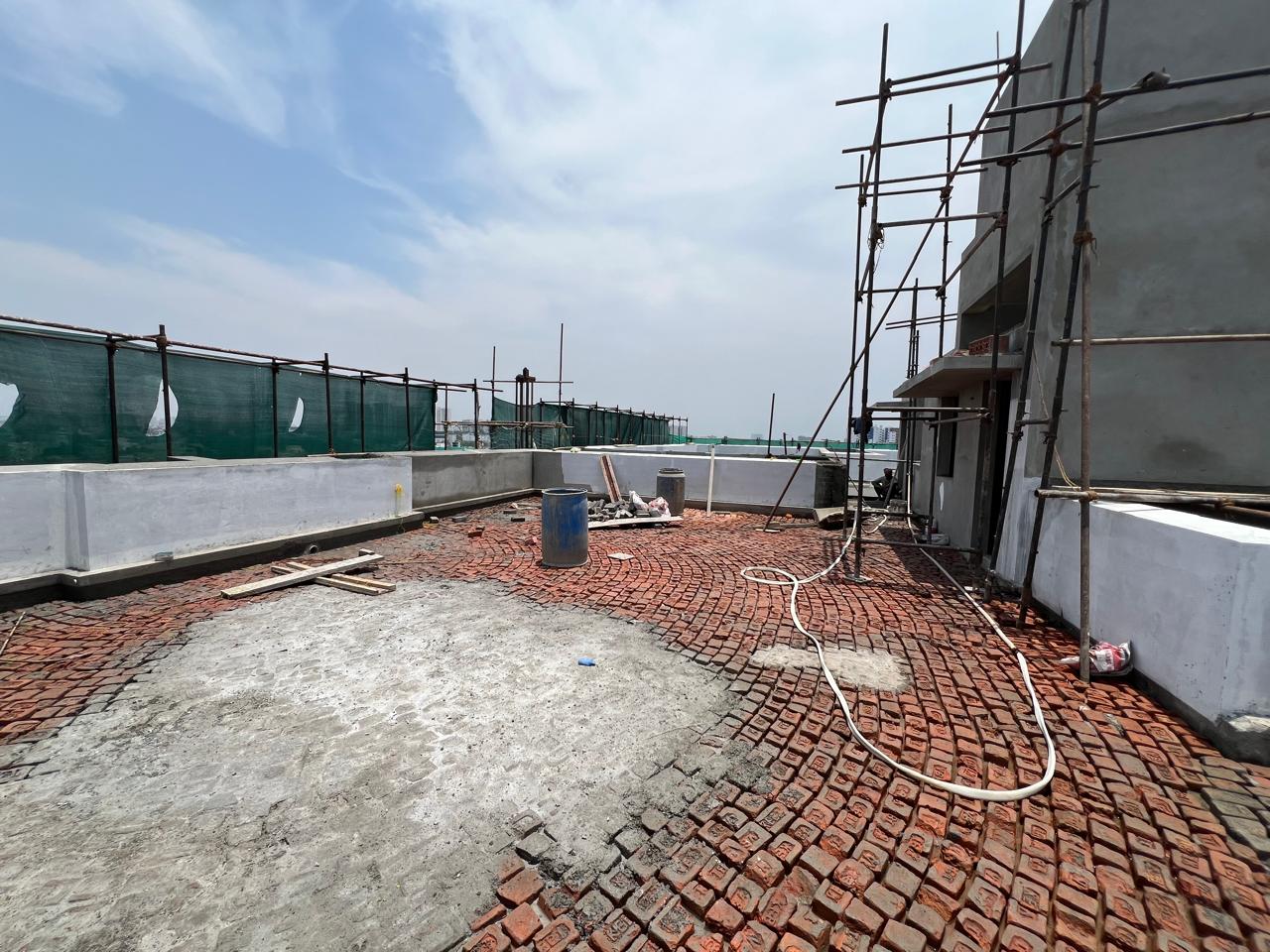

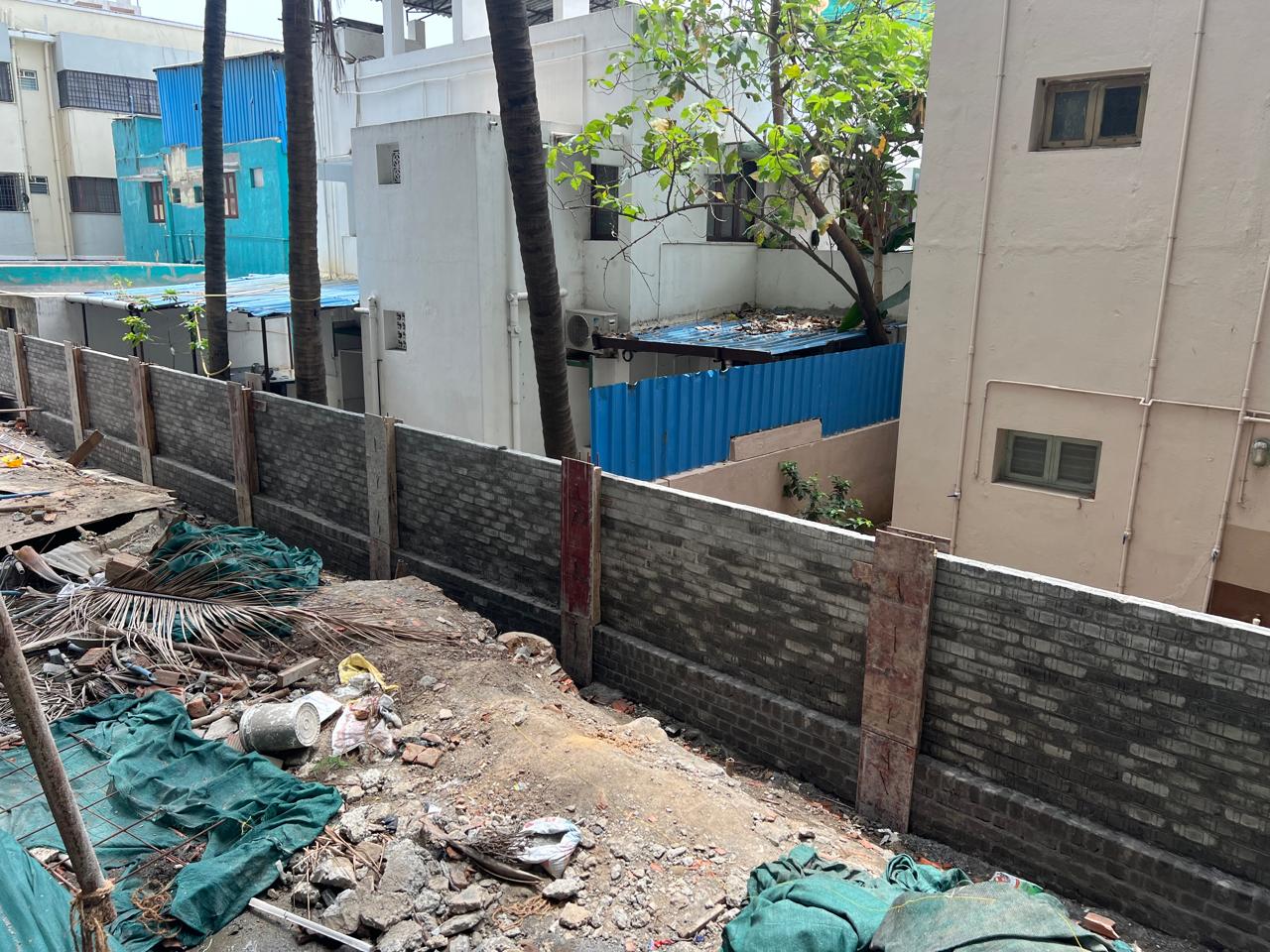

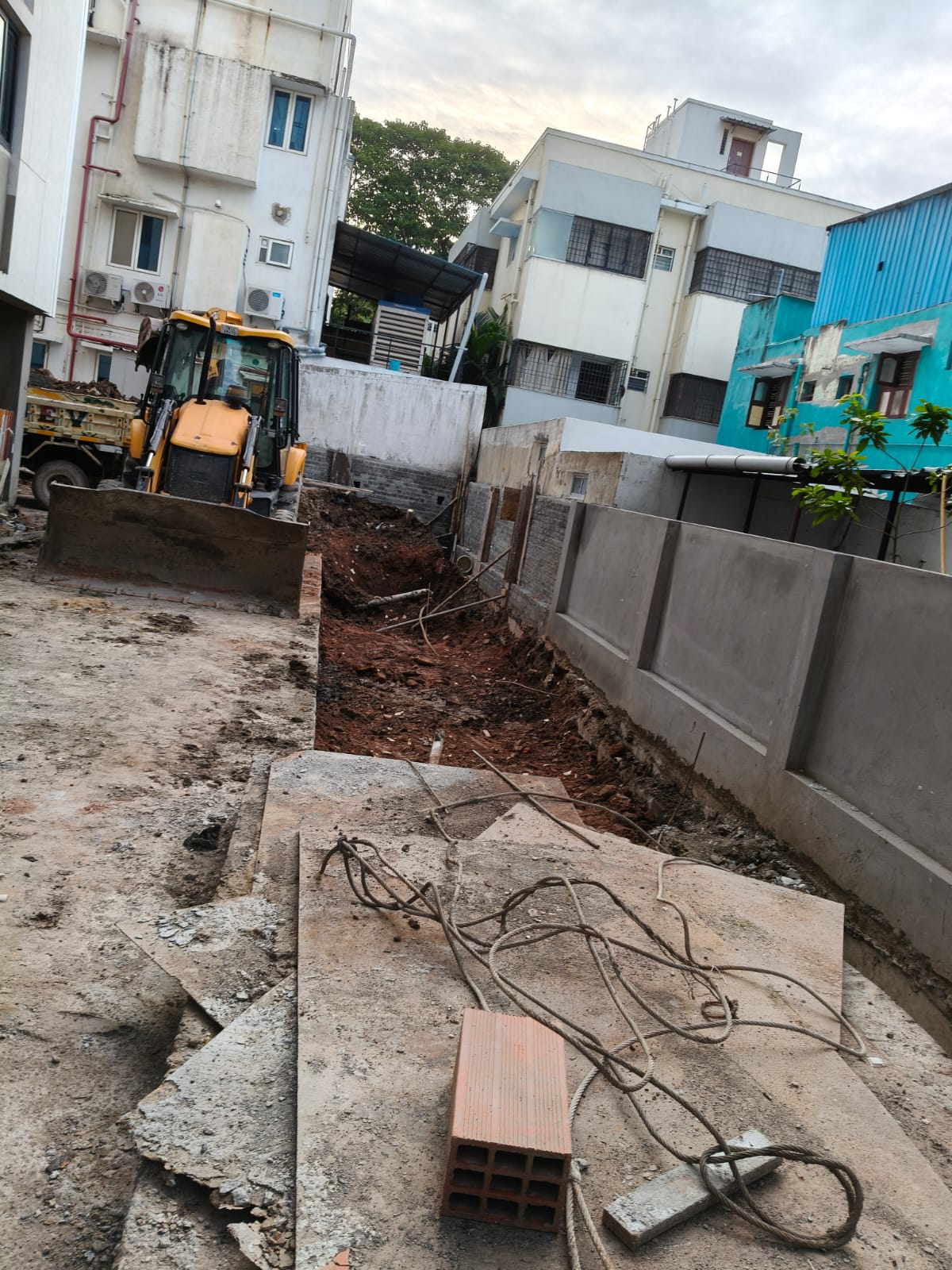

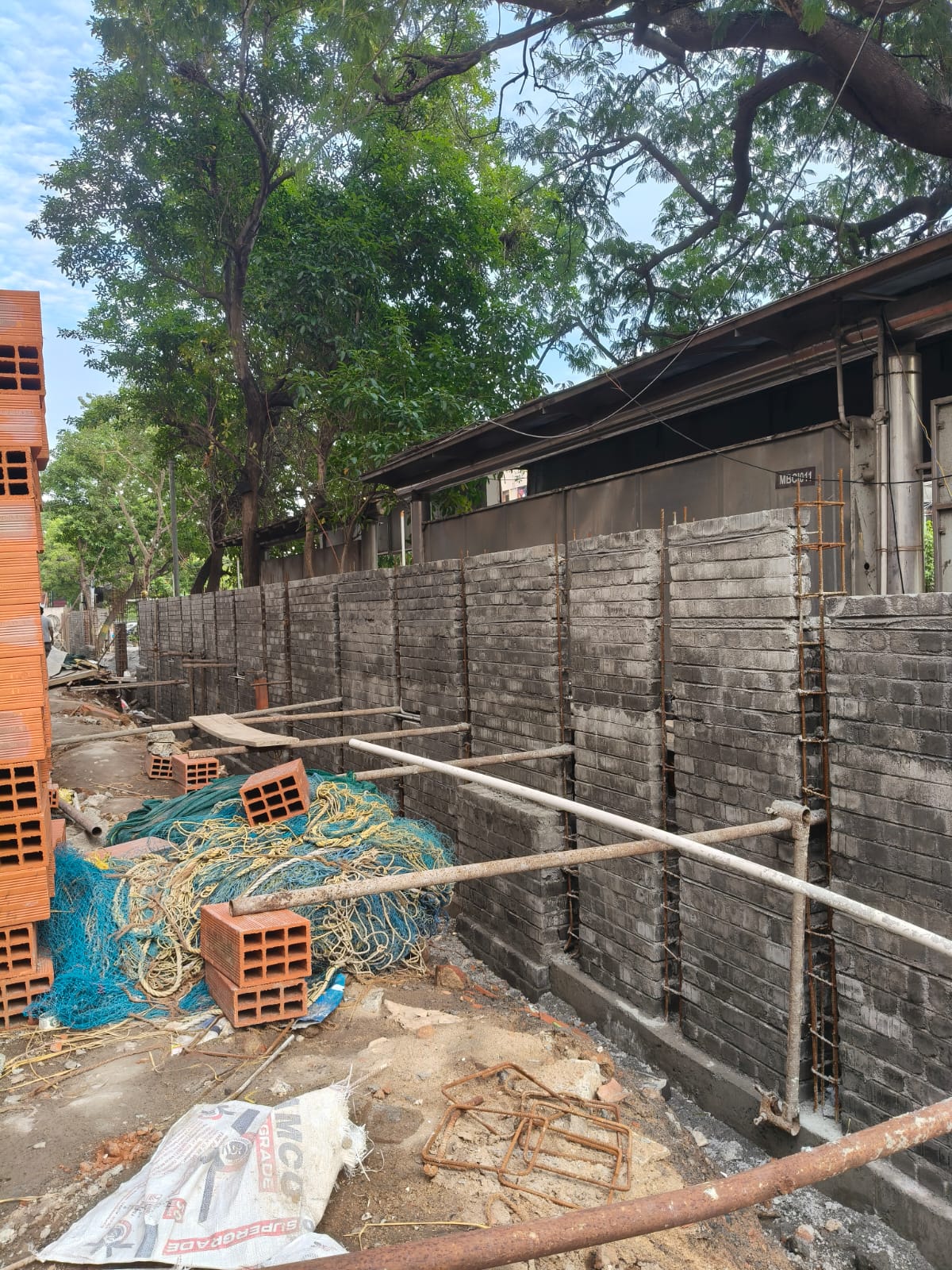

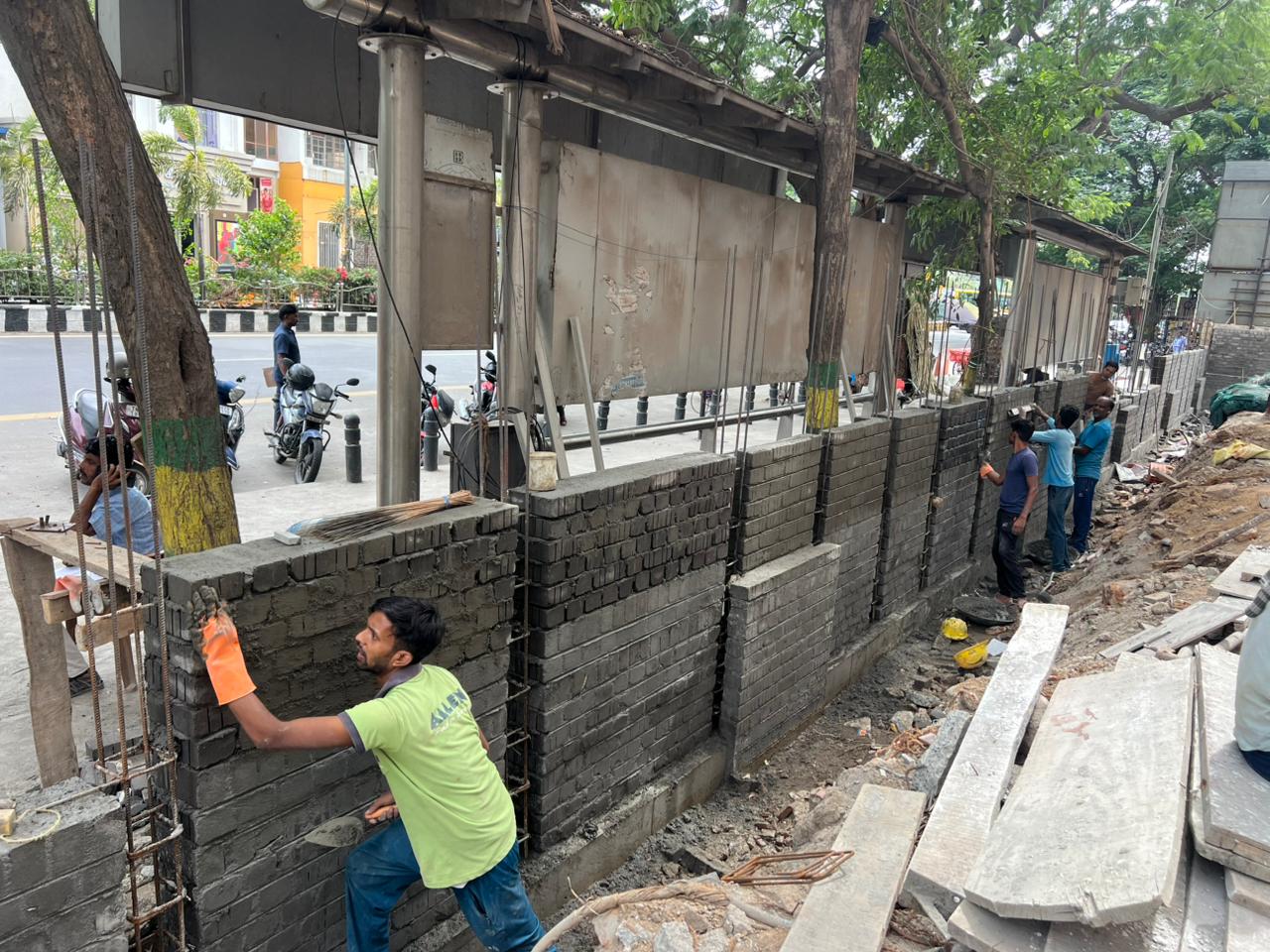

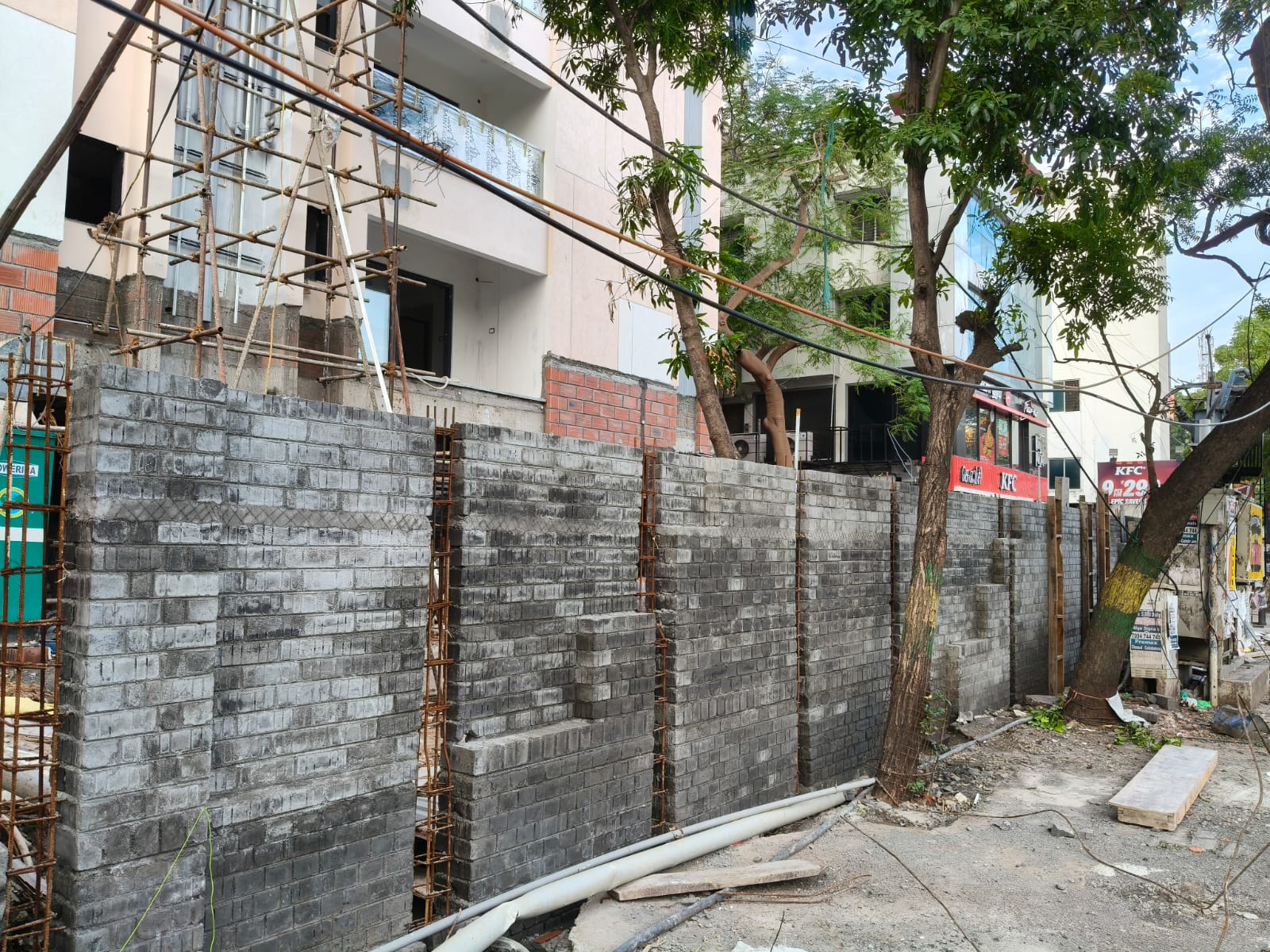

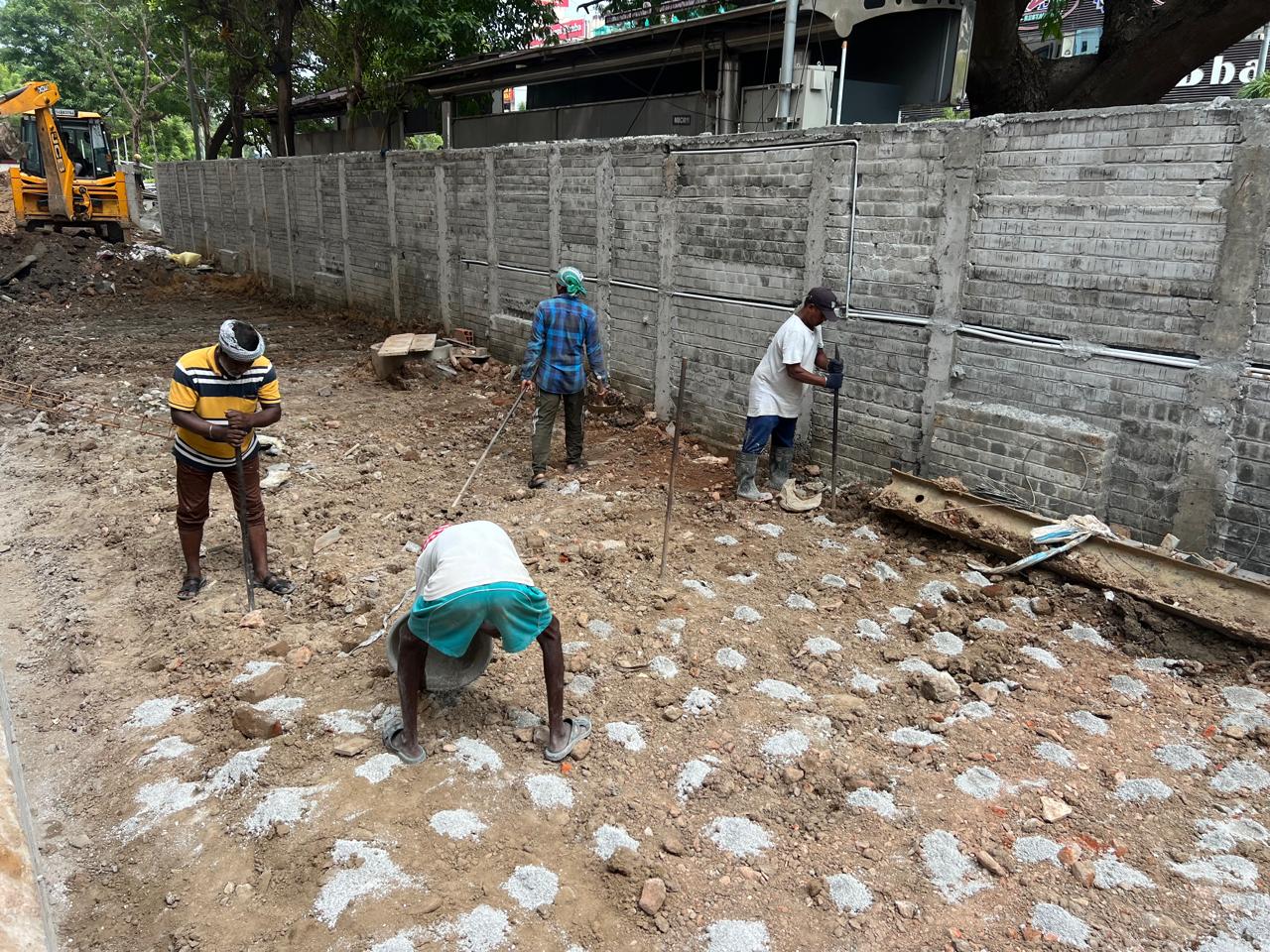

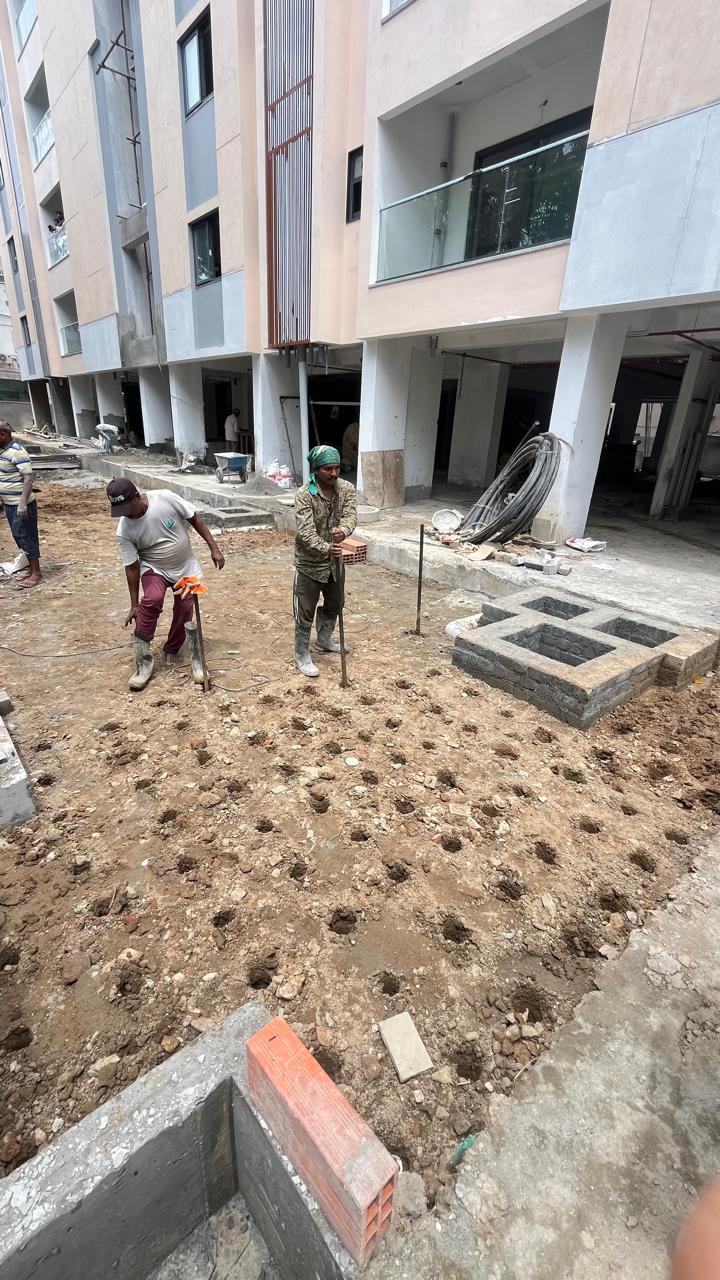

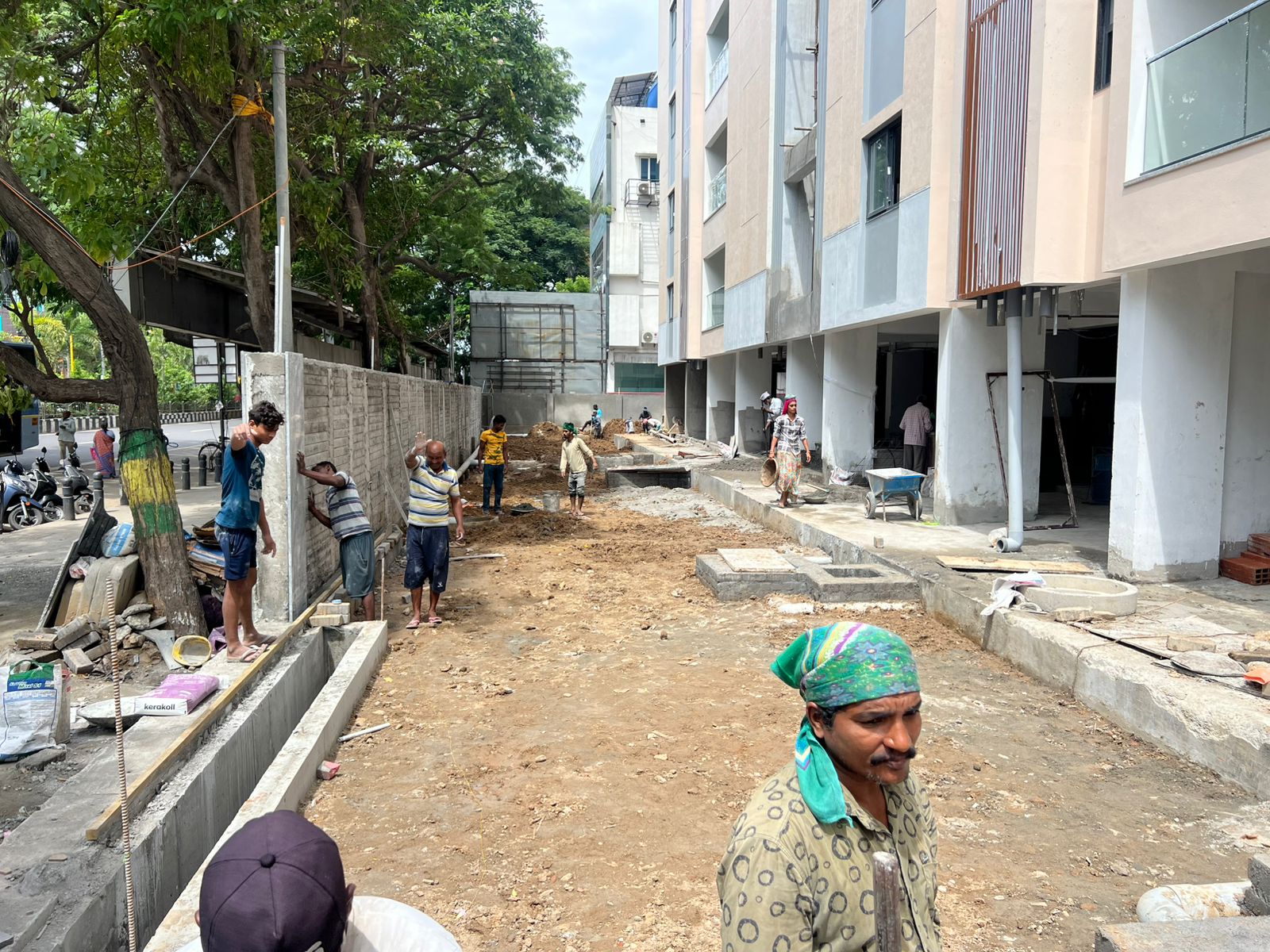

  • Compound wall & gate fixing work is completed.

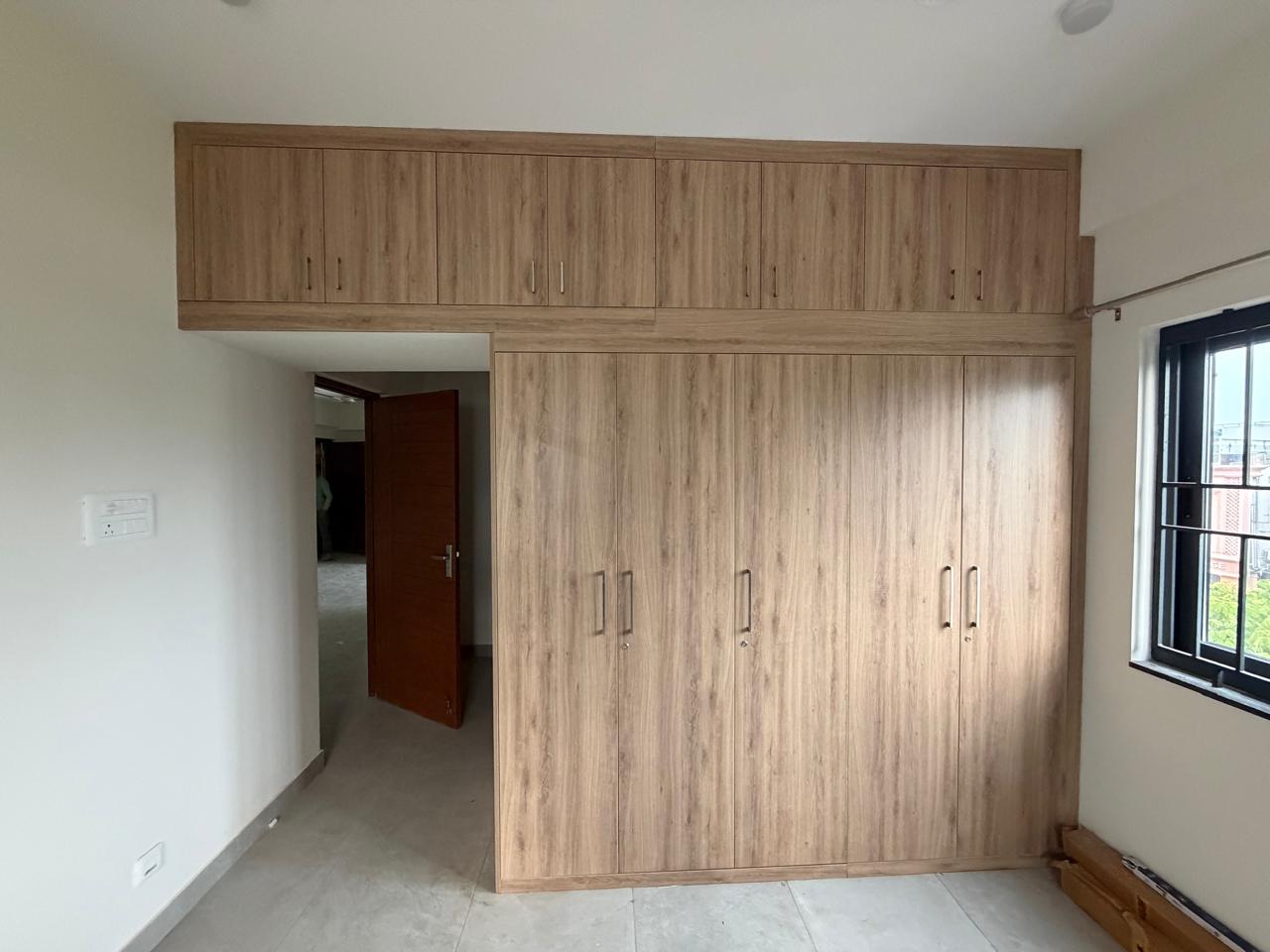

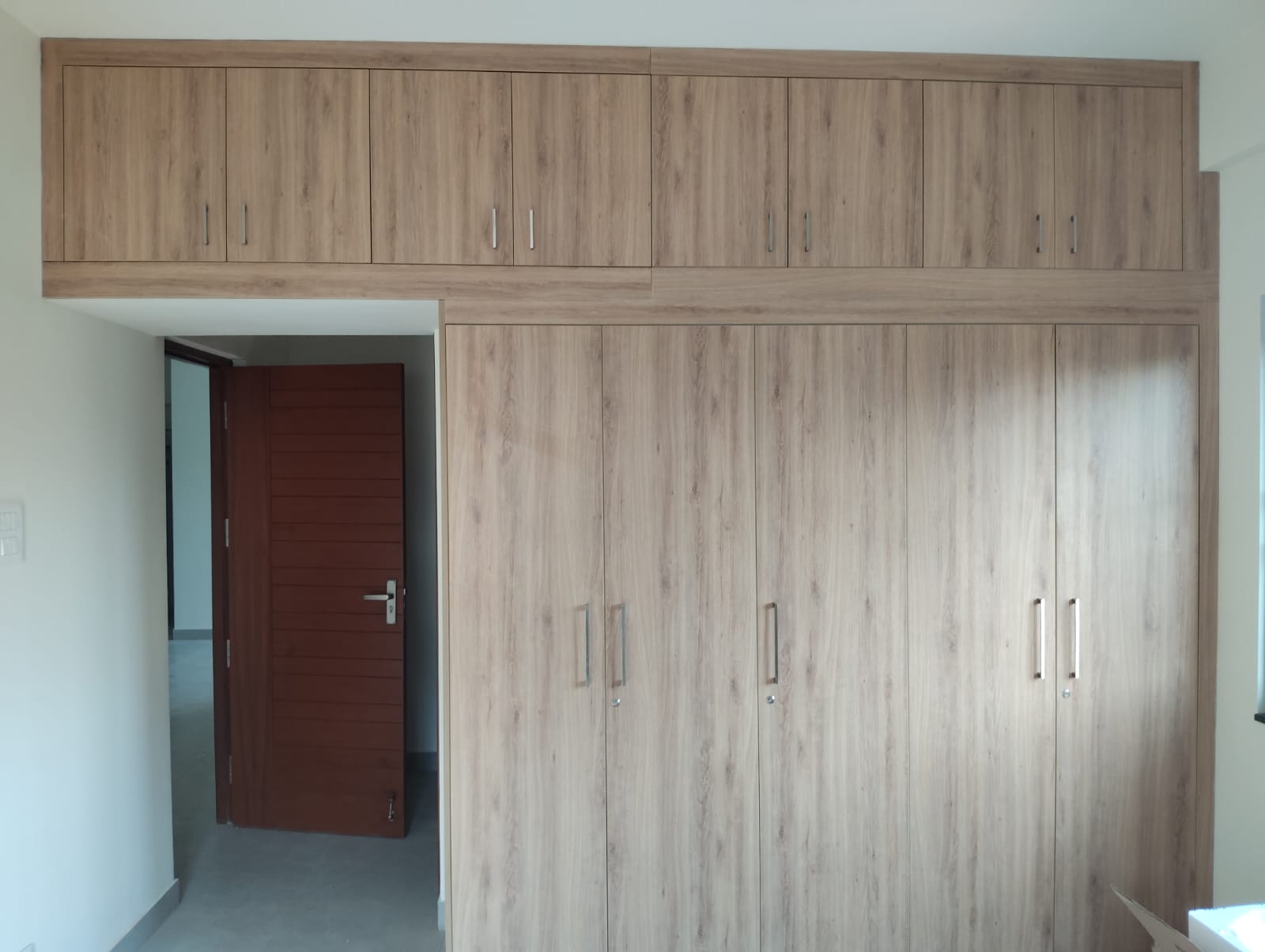

  • Wood work is in progress.( 4 Flat ).
  • Inner primer work is in progress. (upto 9th floor)
  • 9th floor plastering work is in progress.(80% completed)

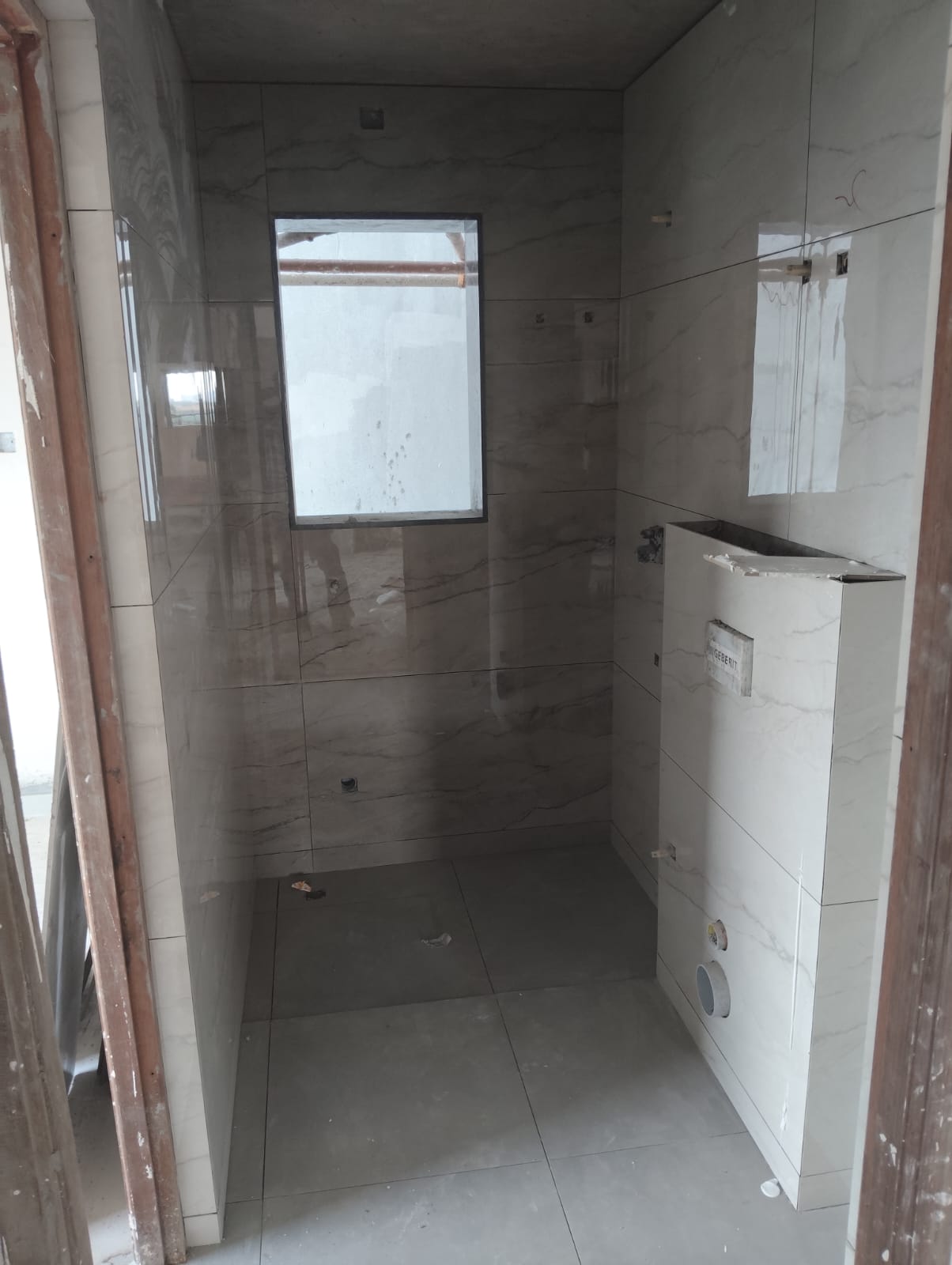

  • Toilet wall tiles work is in progress.(upto 8th floor completed)

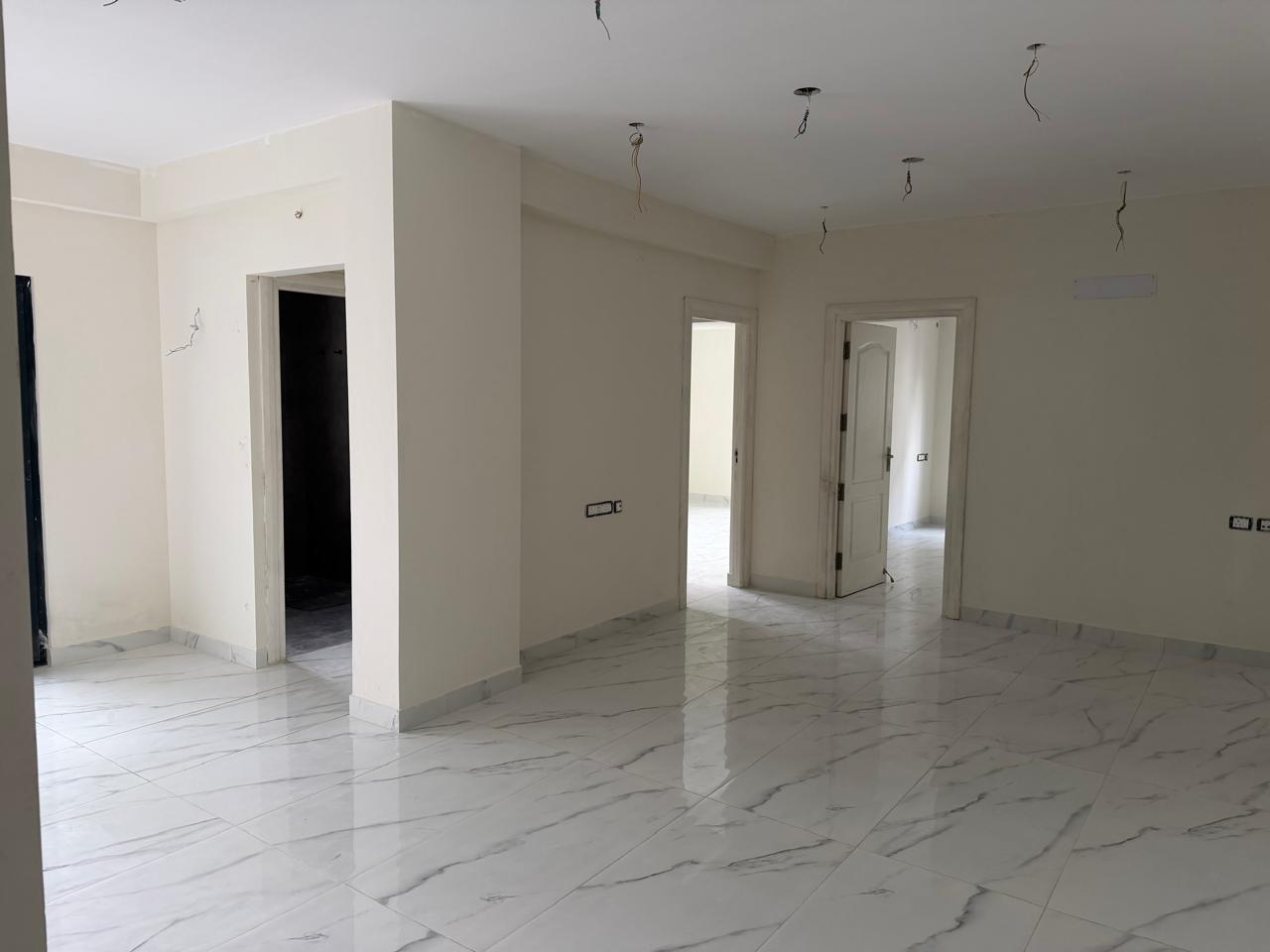

  • General flooring work is in progress.(upto 8th floor completed )
  • Toilet plumbing work is in progress.(upto 9th floor )
  • External texture work is in progress.(75% completed)
  • Lift erection work is in progress.
  • Lift wall cladding work is completed.

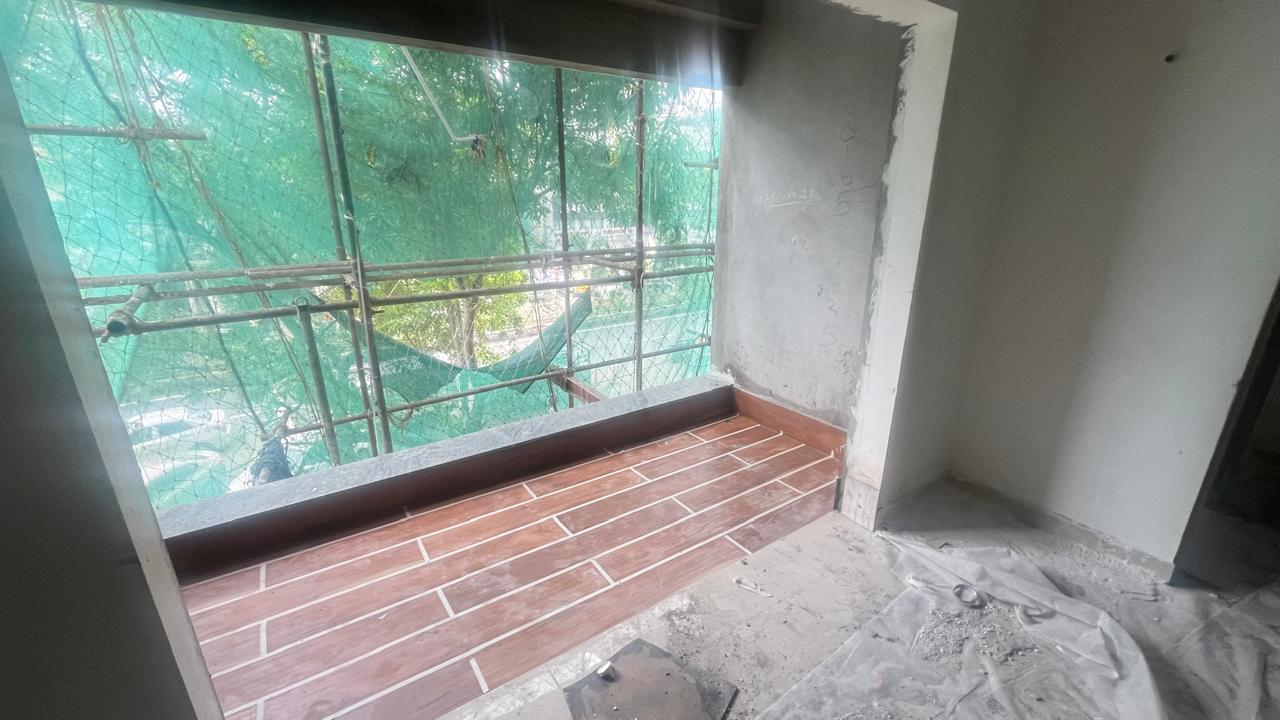

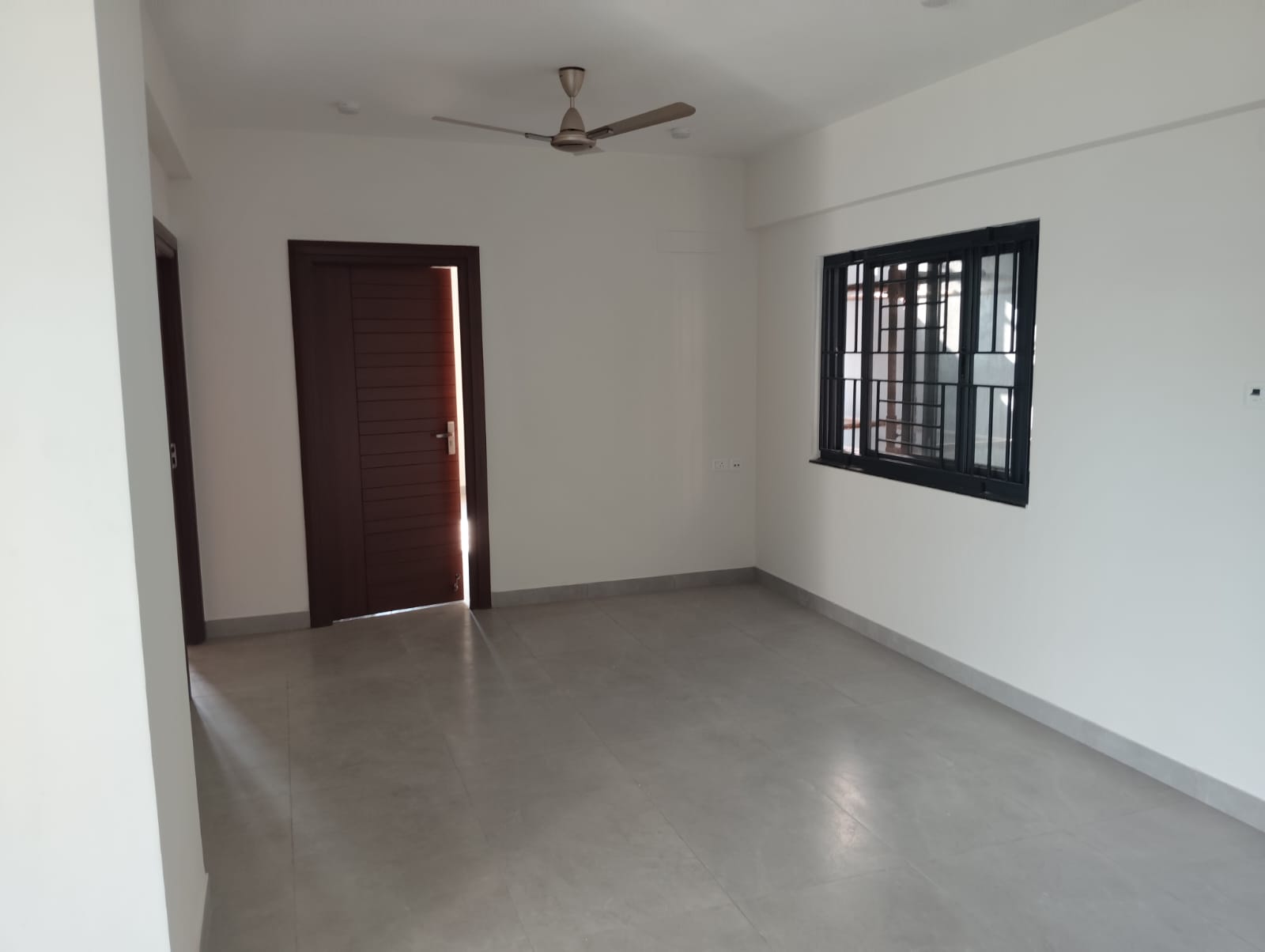

  • All door fixing work is in progress. ( Upto 5th floor completed)
  • Wood work is in progress.( 5 Flat ).
  • Inner primer work is in progress. (upto 9th floor)
  • 9th floor plastering work is completed.
  • Toilet wall tiles work is in progress.(upto 8th floor completed)
  • General flooring work is in progress.(upto 8th floor completed )
  • Outer painting 1st coat work is in progress.(60% completed )
  • Toilet plumbing work is in progress.(upto 9th floor )

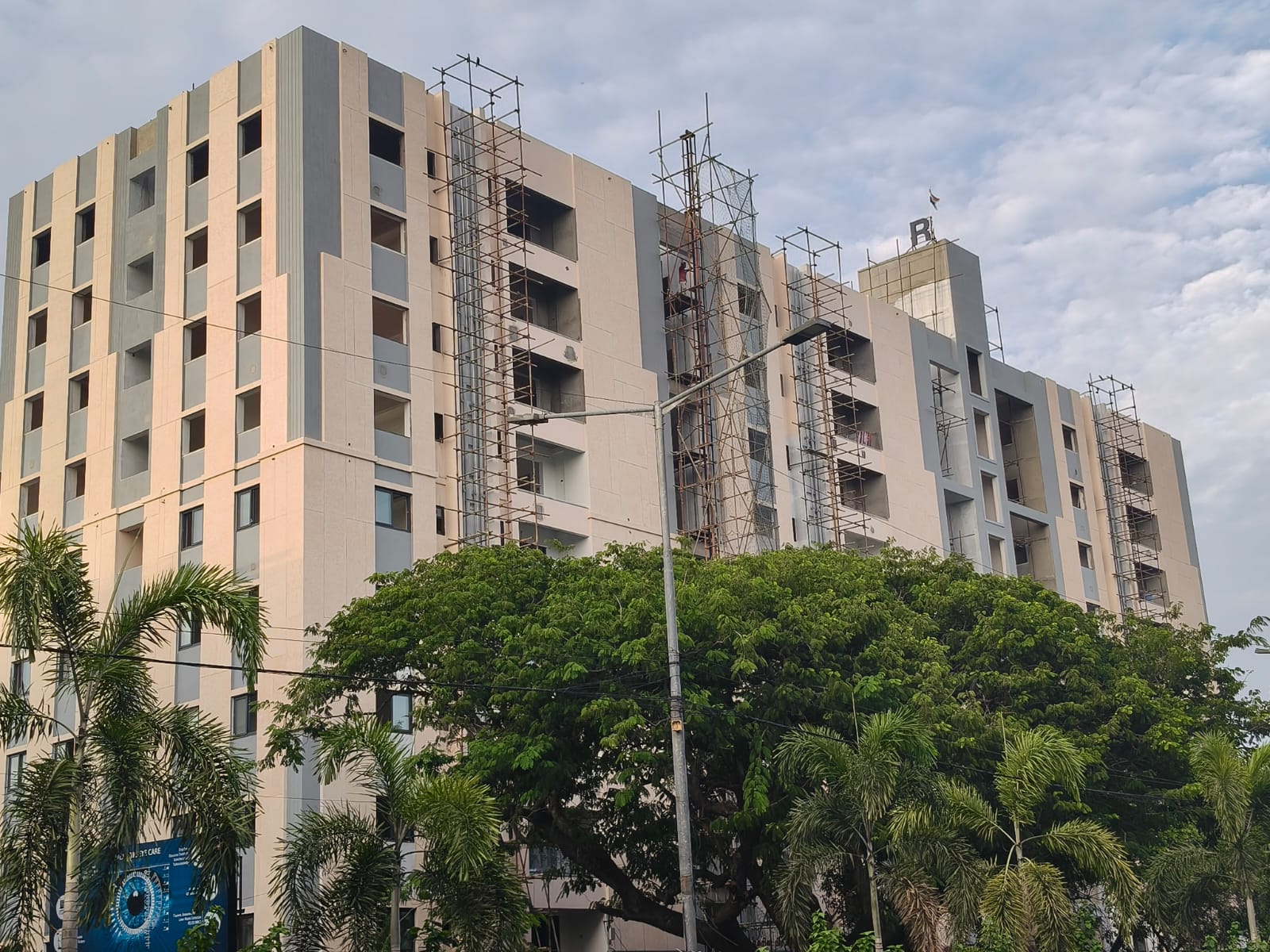

  • External texture work is in progress.(80% completed)
  • Lift erection work is in progress.(1/2 completed)
  • Lift wall cladding work is completed.
  • All door fixing work is in progress. ( Upto 6th floor completed)
  • Wood work is in progress.( 5 flat progress ).
  • Inner primer work is in progress. (upto 9th floor)
  • 9th floor plastering work is completed.
  • Toilet wall tiles work is in progress.(upto 8th floor completed)
  • General flooring work is in progress.(upto 8th floor completed )
  • Outer painting 1st coat work is in progress.(60% completed )
  • Toilet plumbing work is completed.
  • External texture work is in progress.(80% completed)
  • Lift erection work is in progress.(1/2 completed)
  • Lift wall cladding work is completed.
  • All door fixing work is in progress. ( Upto 7th floor completed)
