Lakshmi

Adyar

Download Brochure

Download file

Enquire Now

Amenities

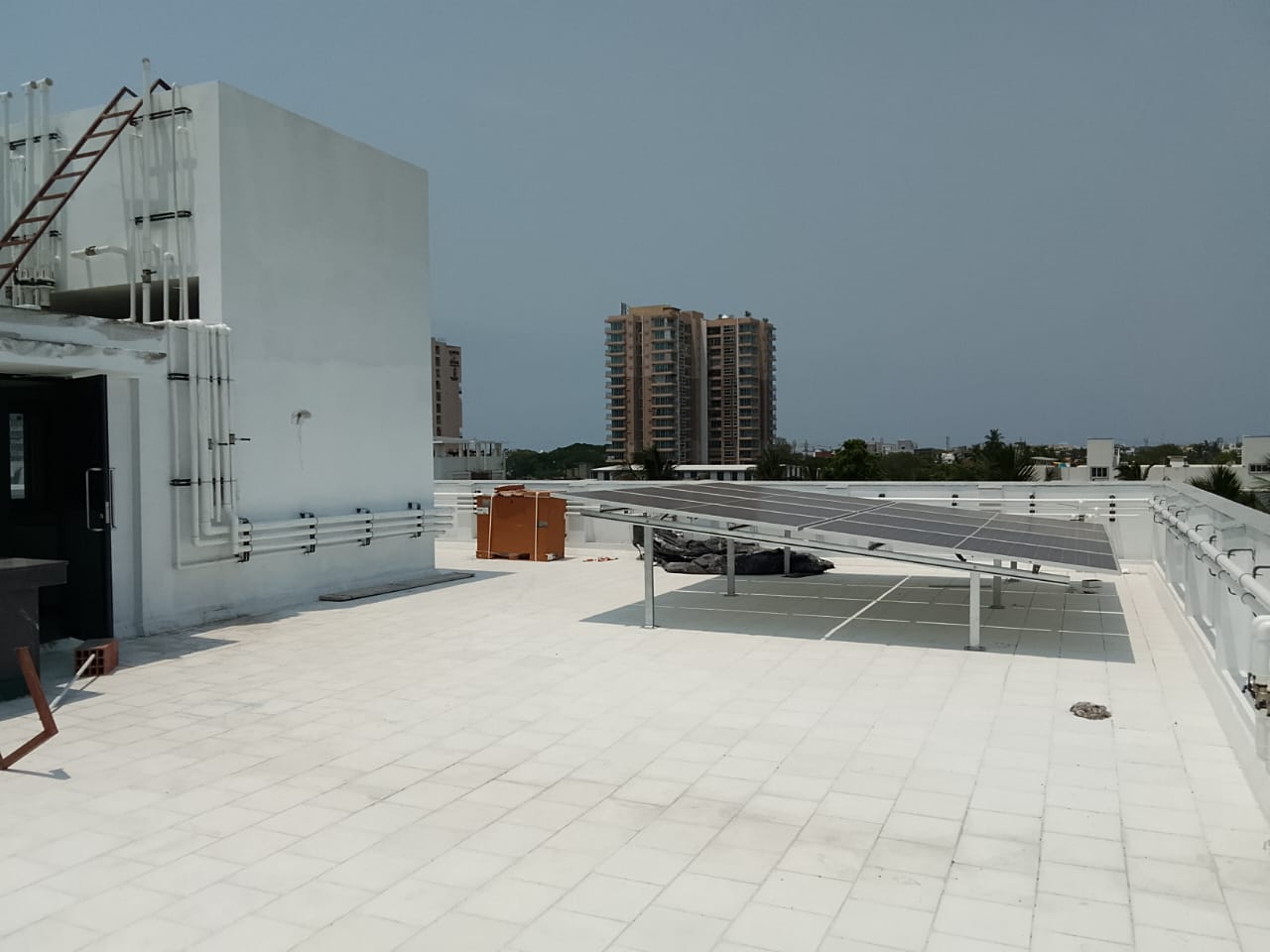

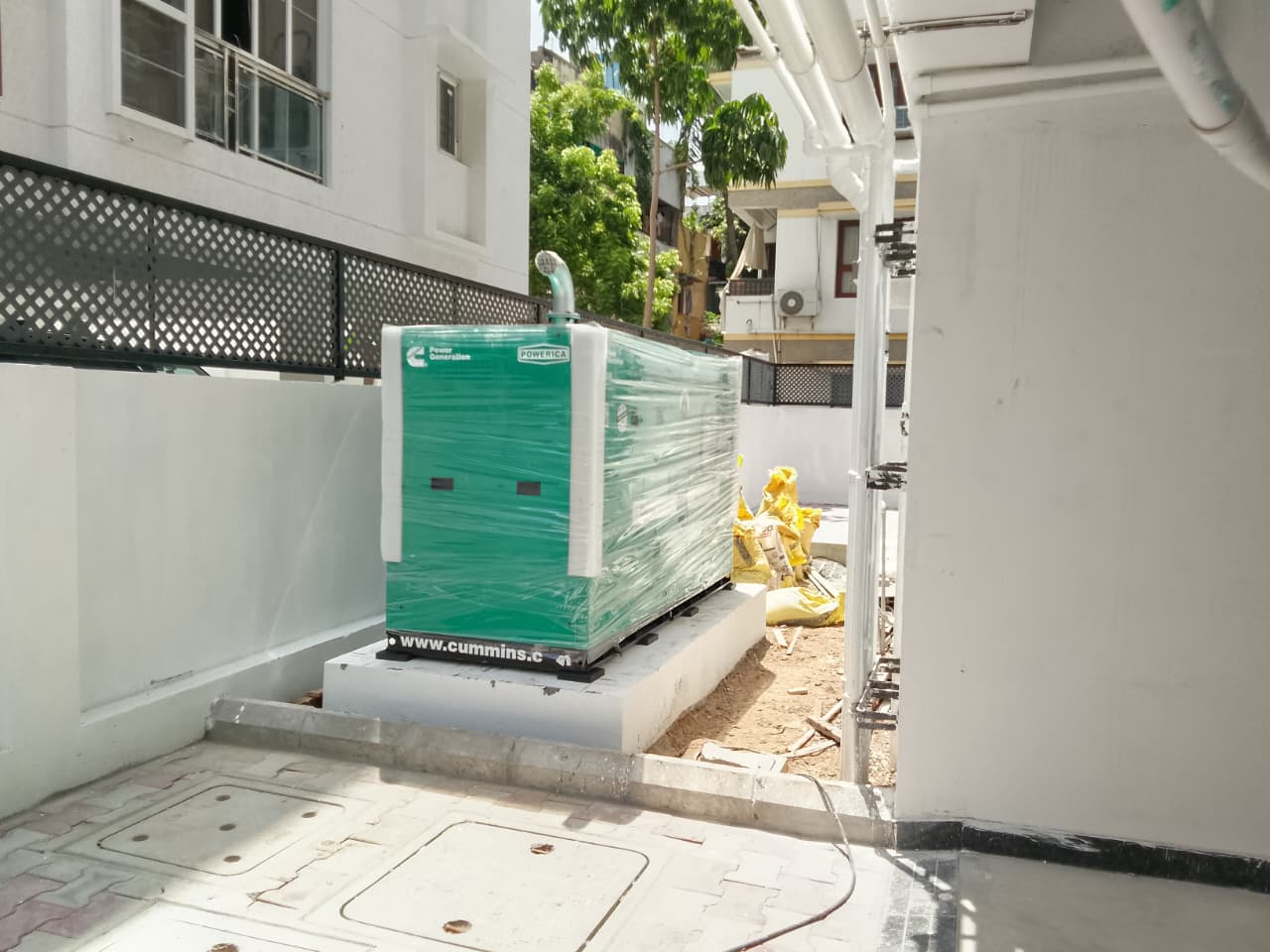

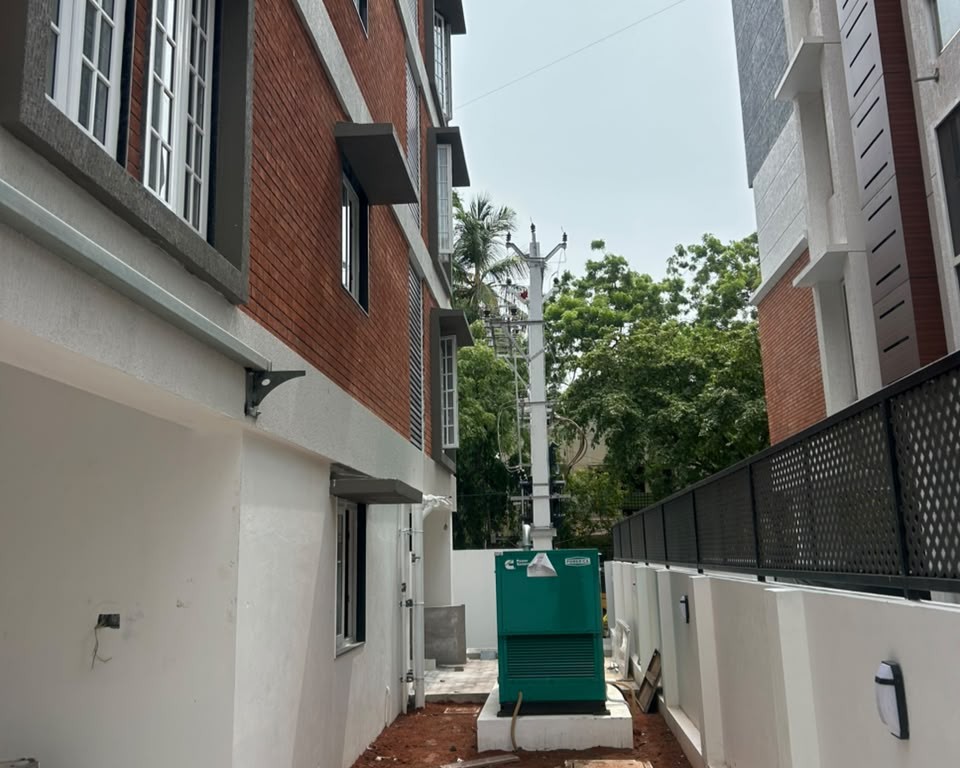

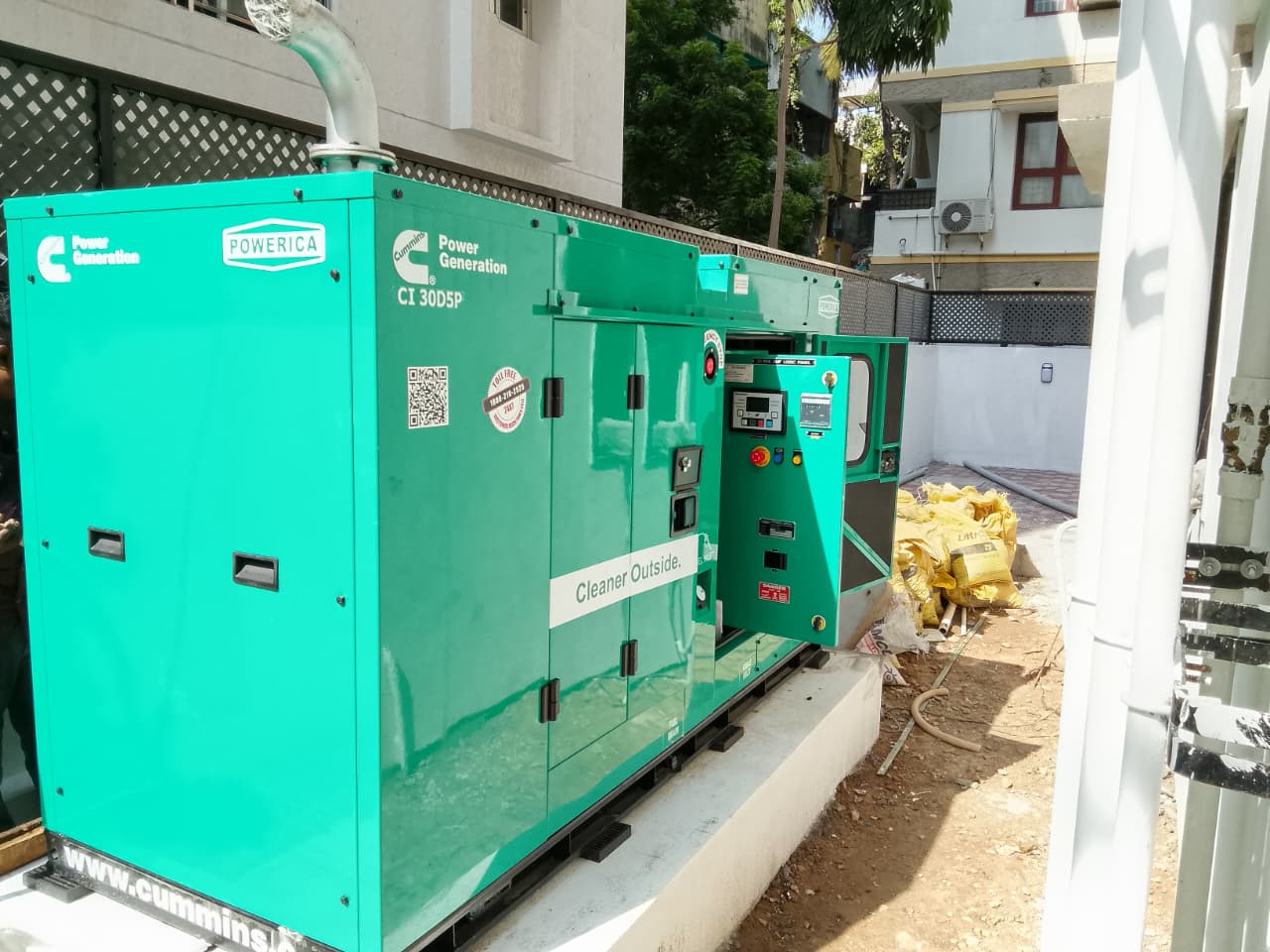

Generator Backup
CCTV
Rain Water Harvesting
Intercom

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
5A 5 4BHK + 3T 2216 North Sold Out
3A 3 4BHK + 3T 2216 North Sold Out
4A 4 4BHK + 3T 2216 North Sold Out

Approvals

Planning Permit No:

OL-PP/NHRB/0343/2024 OL-00987

Date of Permit:

2024-06-19

Building Permission No:

CEBA/WDCN13/00294/2024

Date of Permit:

2024-07-01

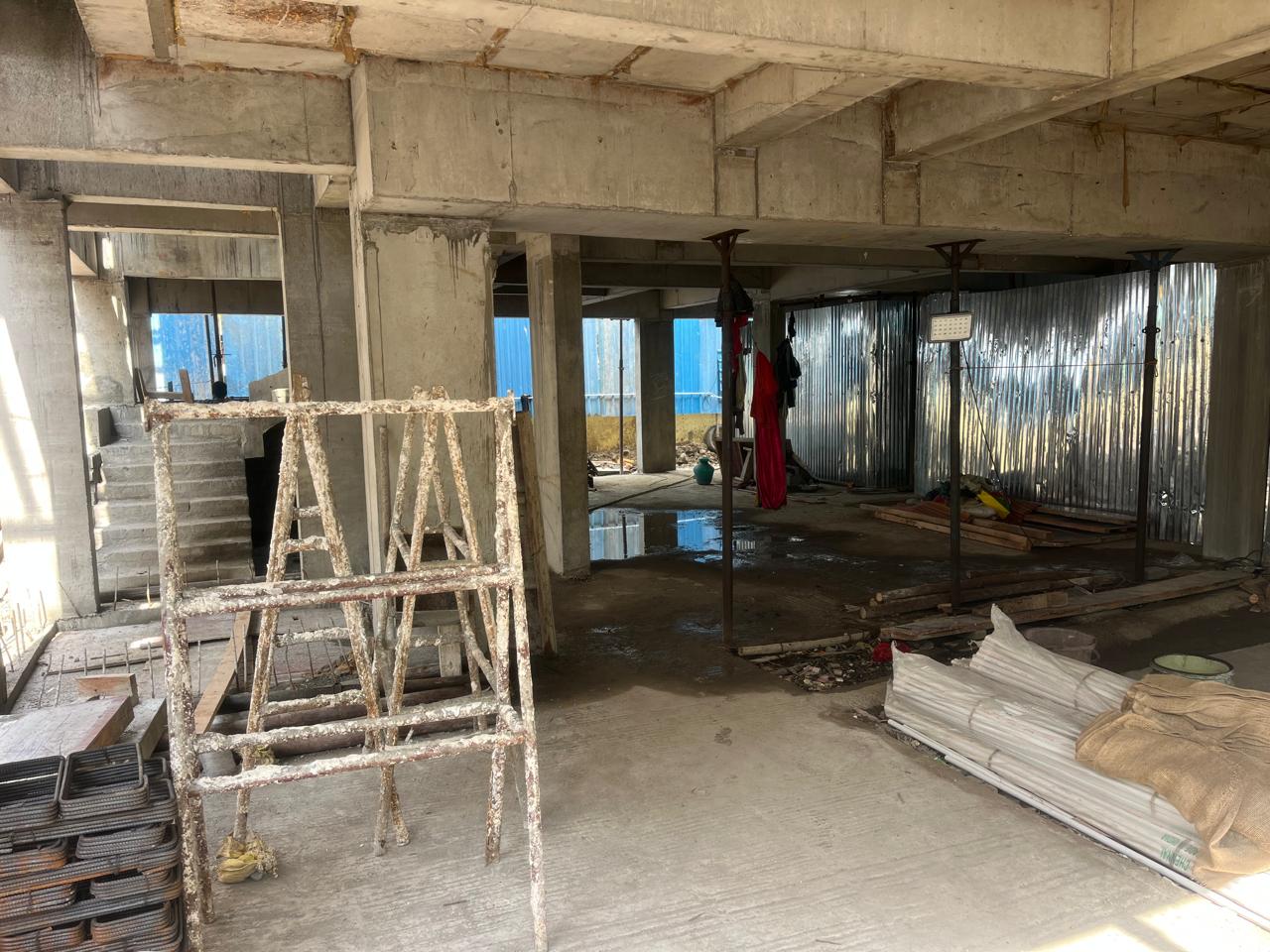

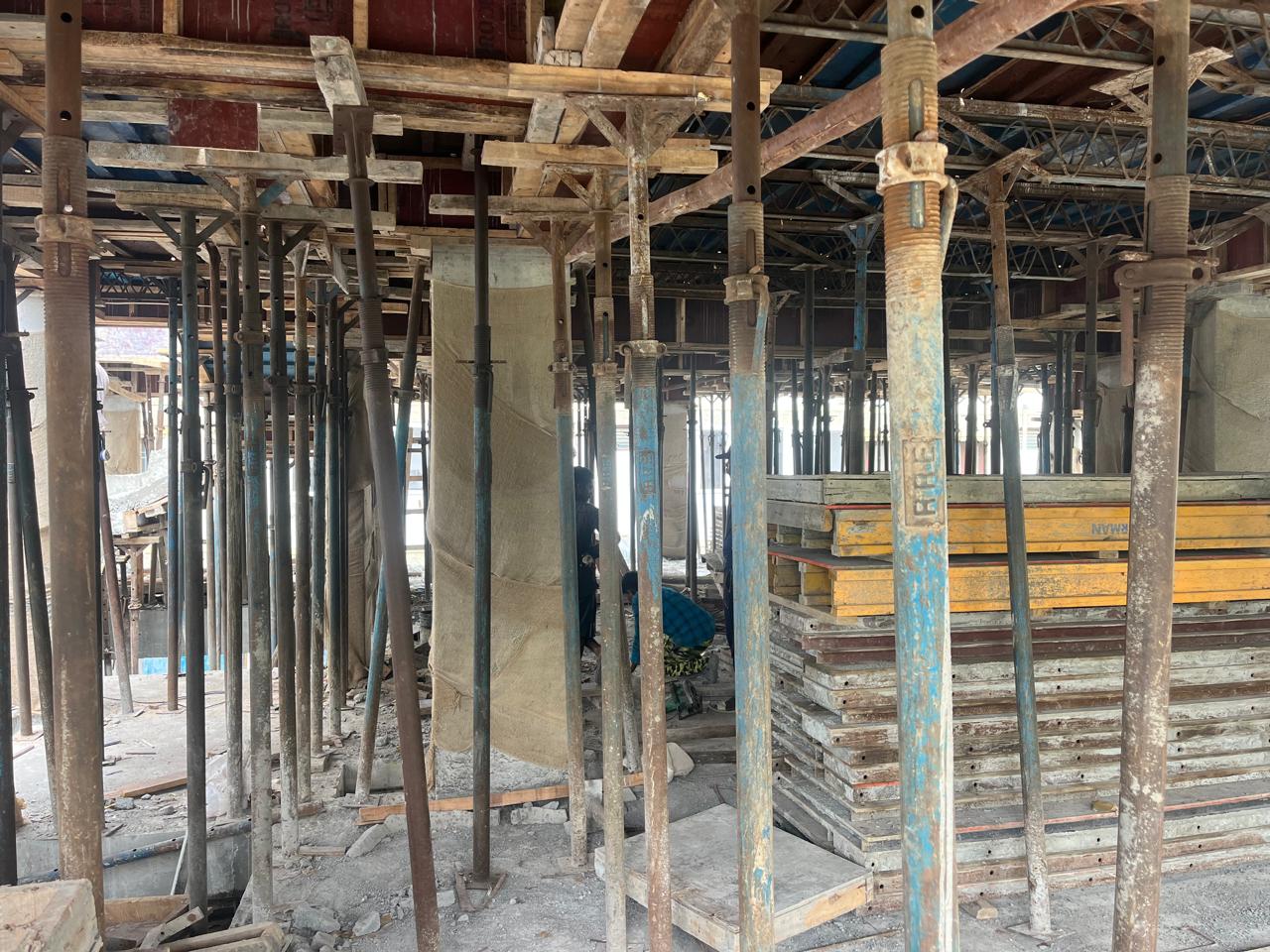

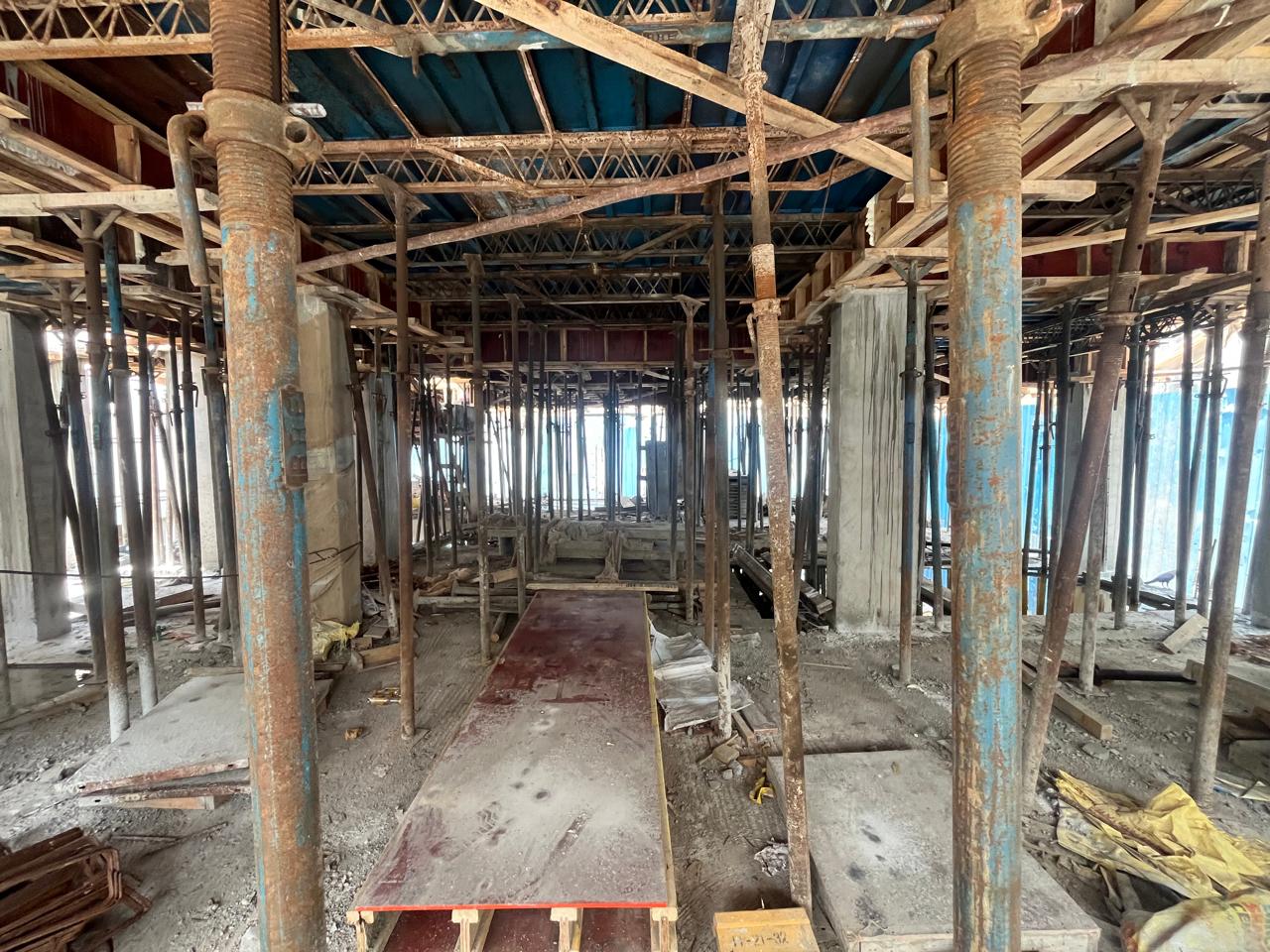

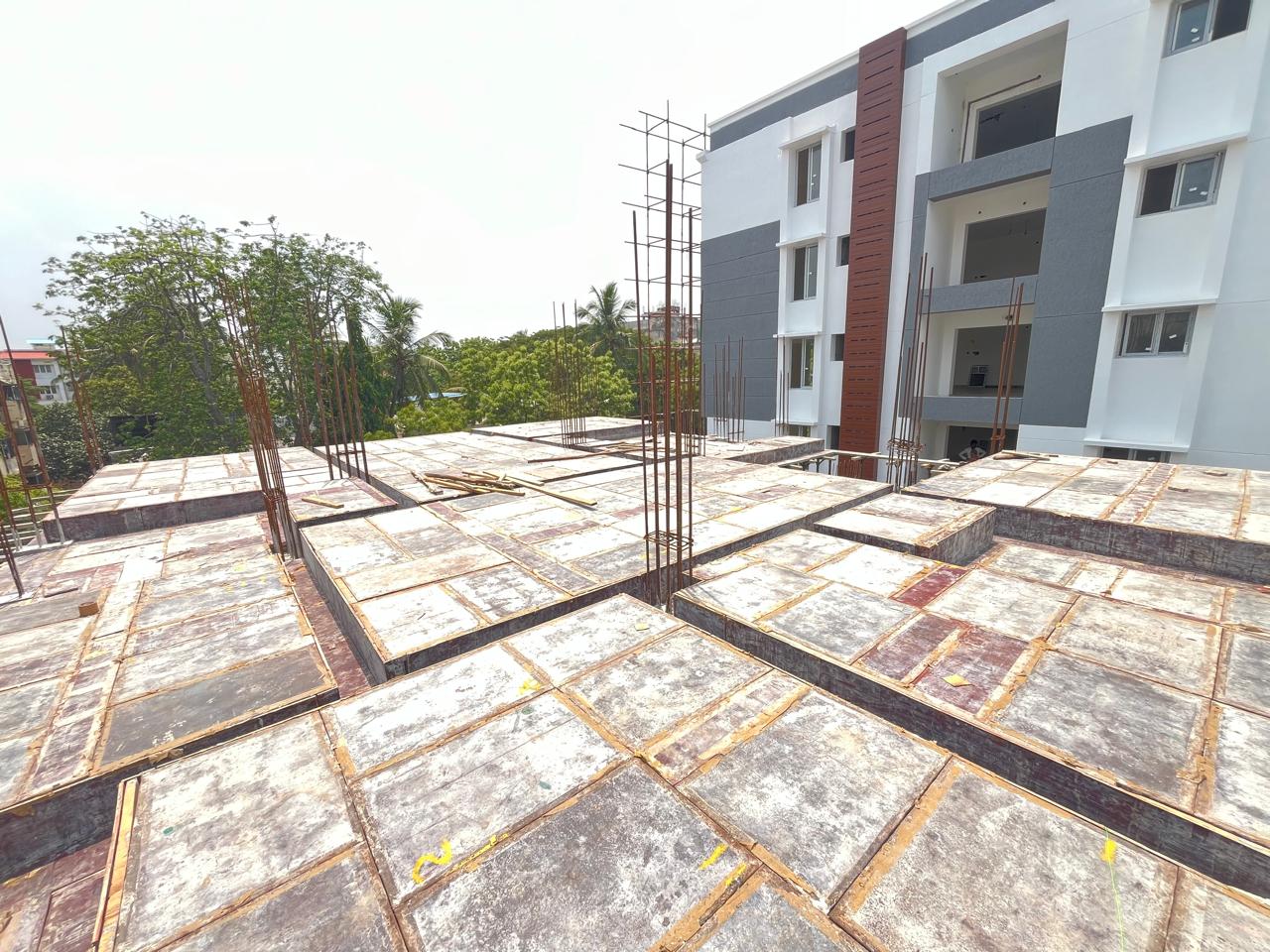

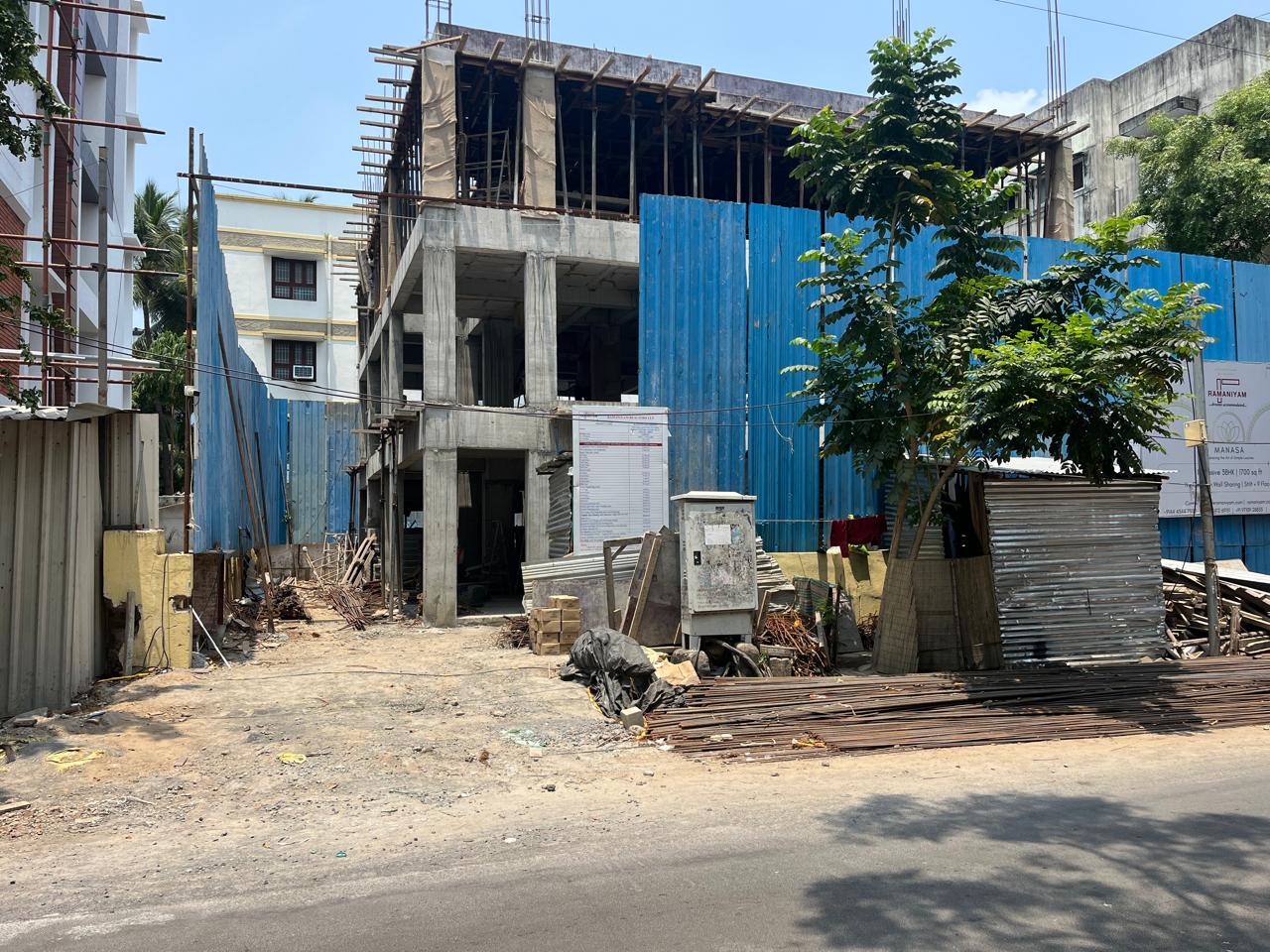

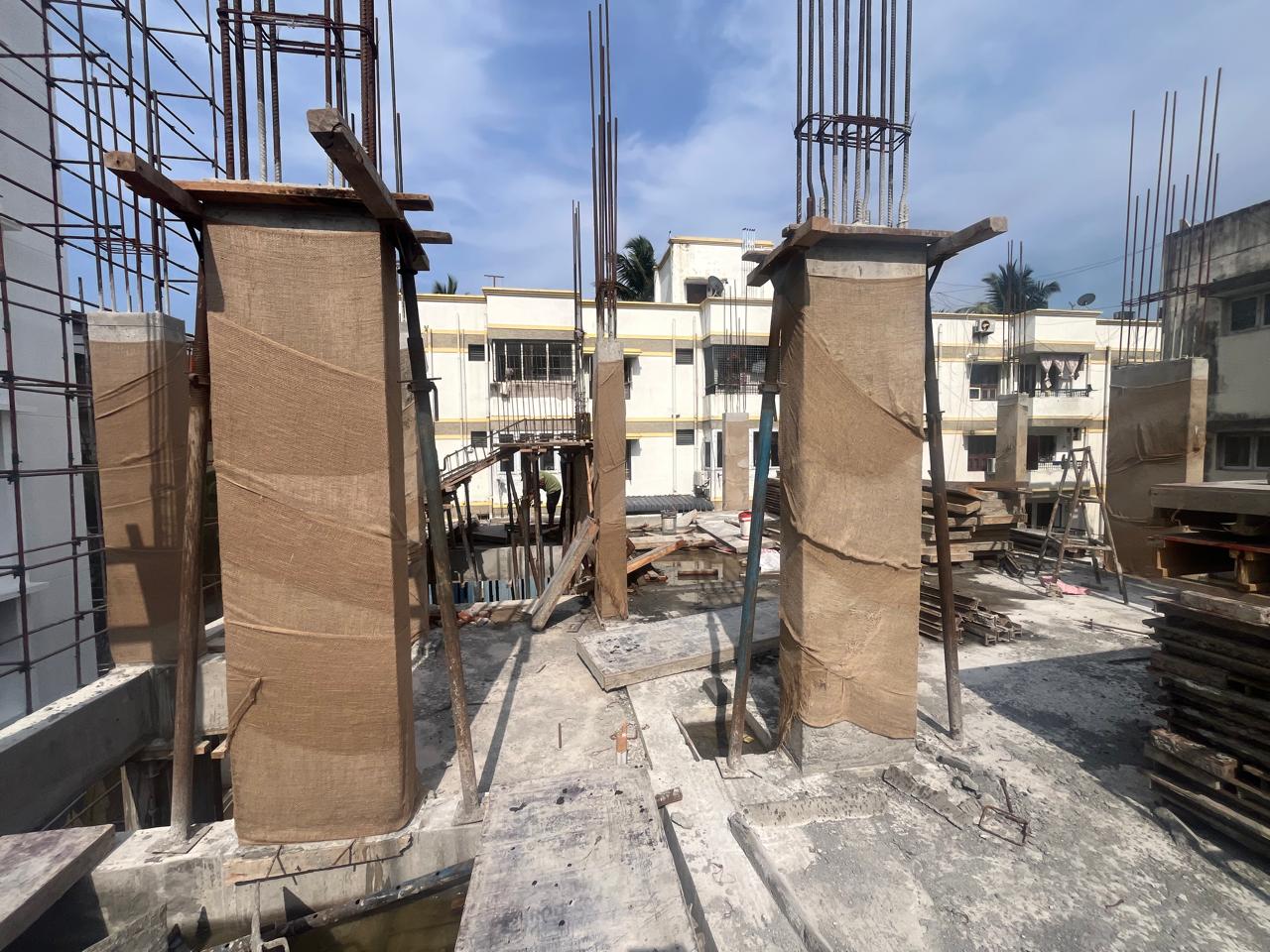

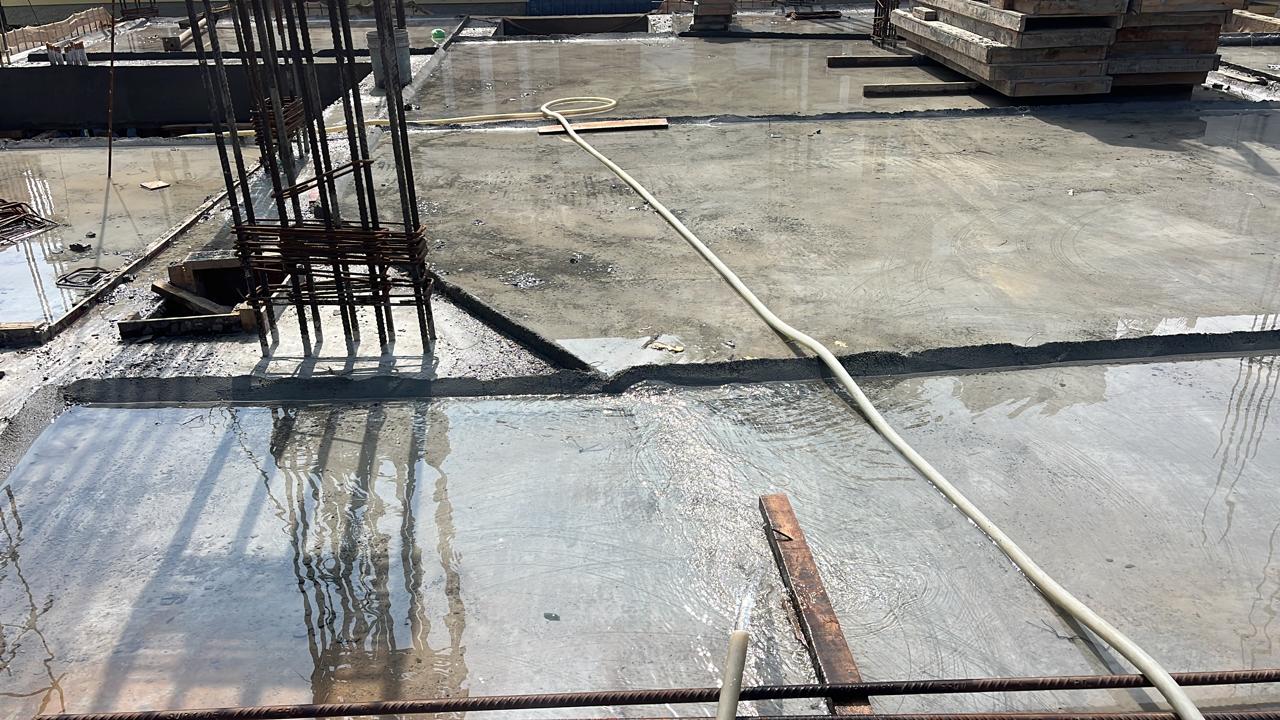

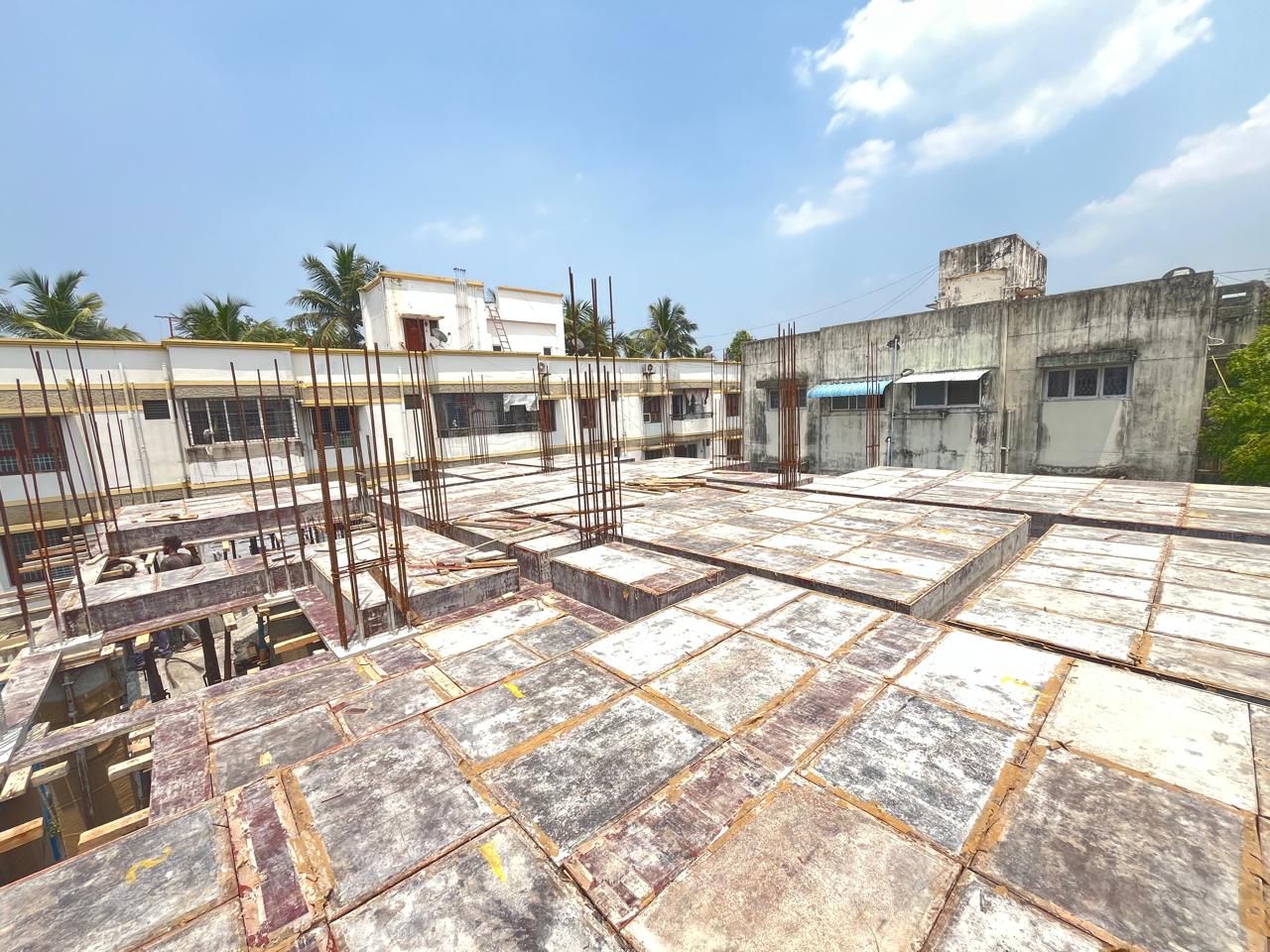

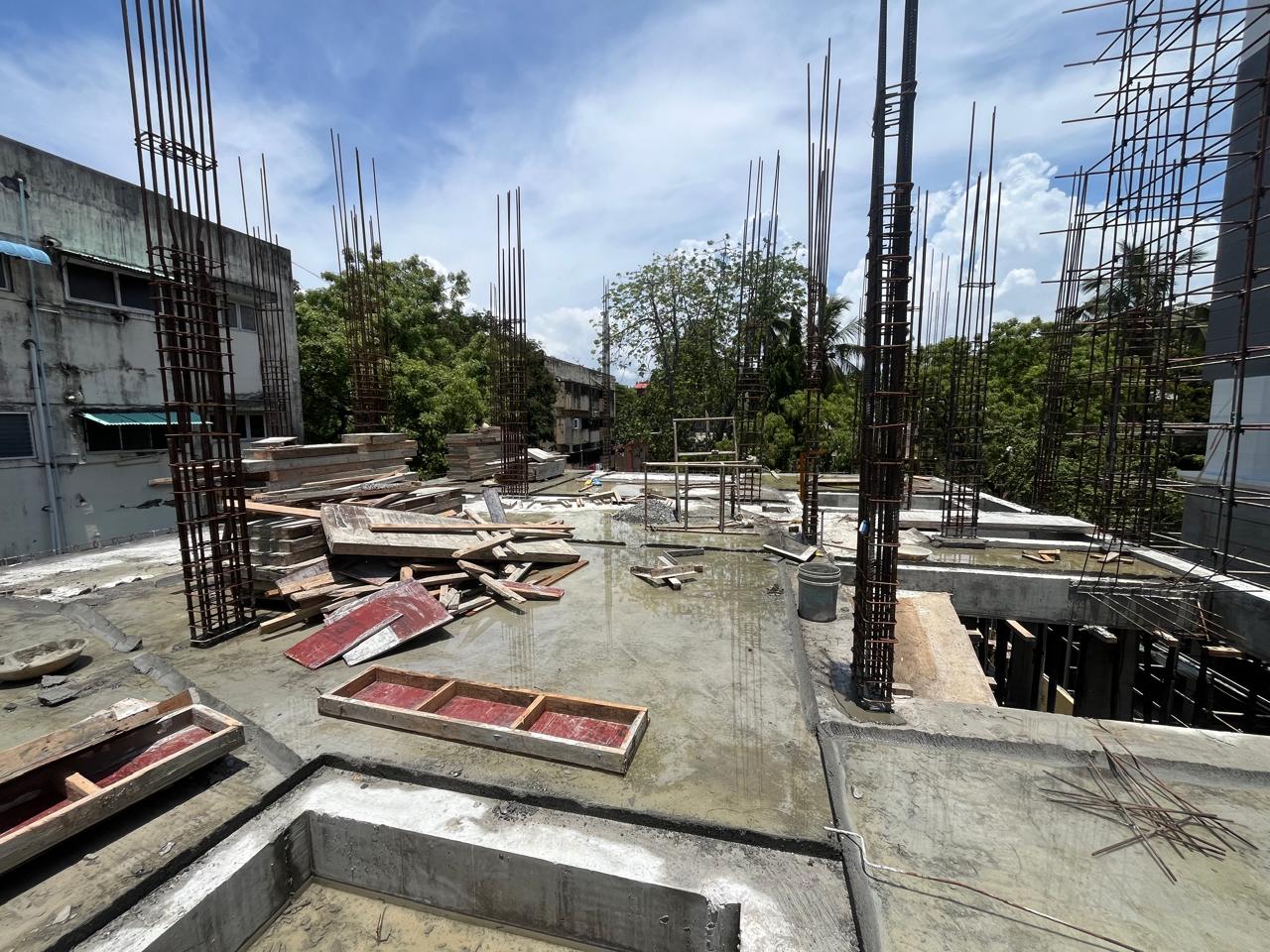

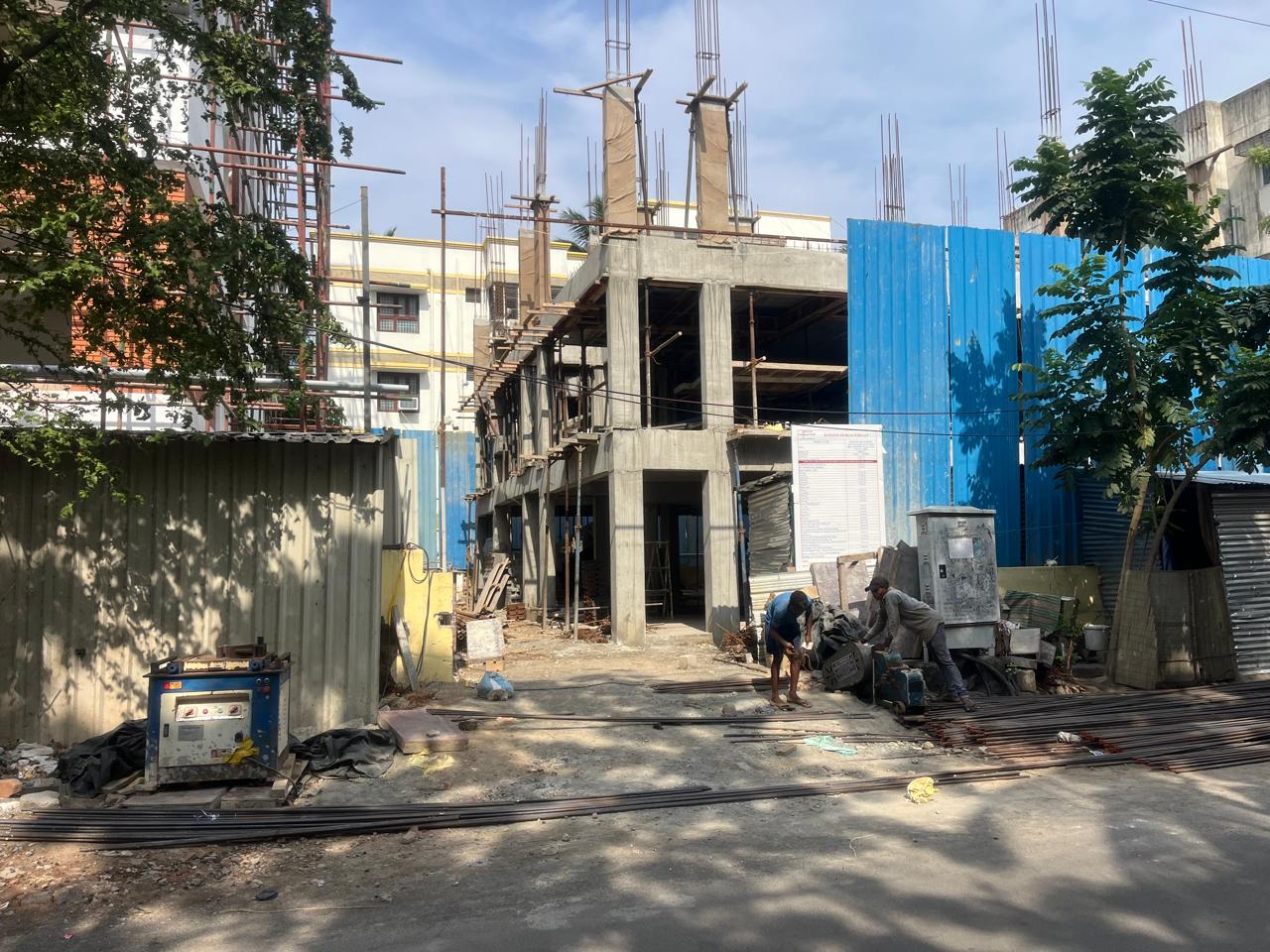

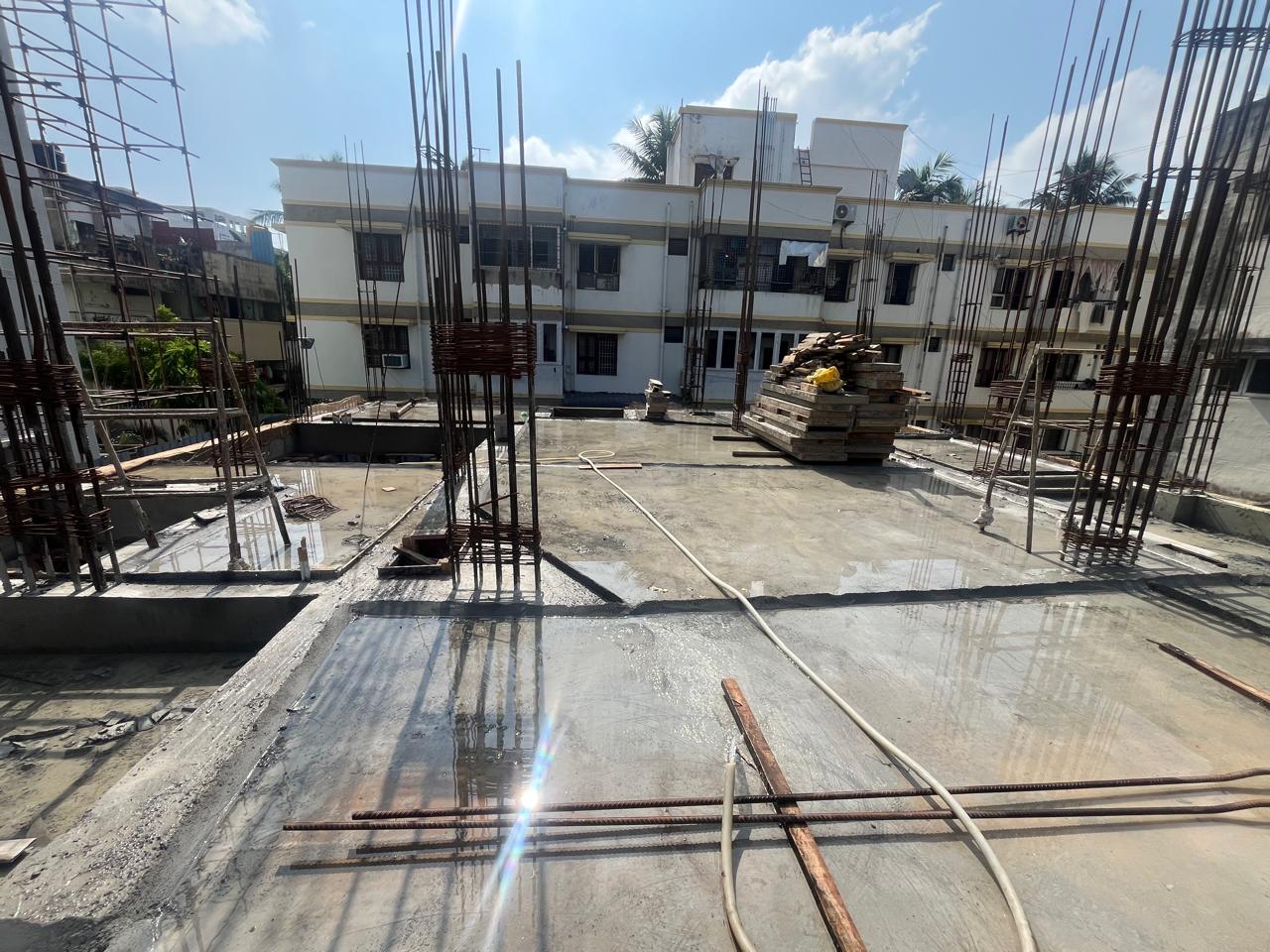

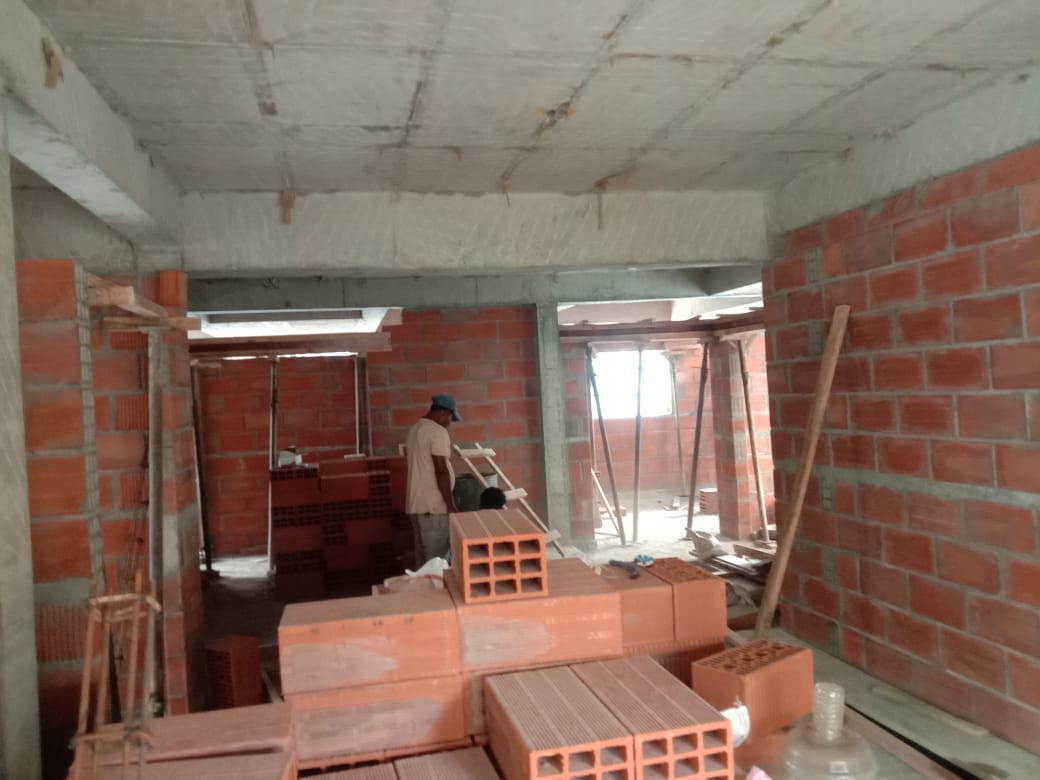

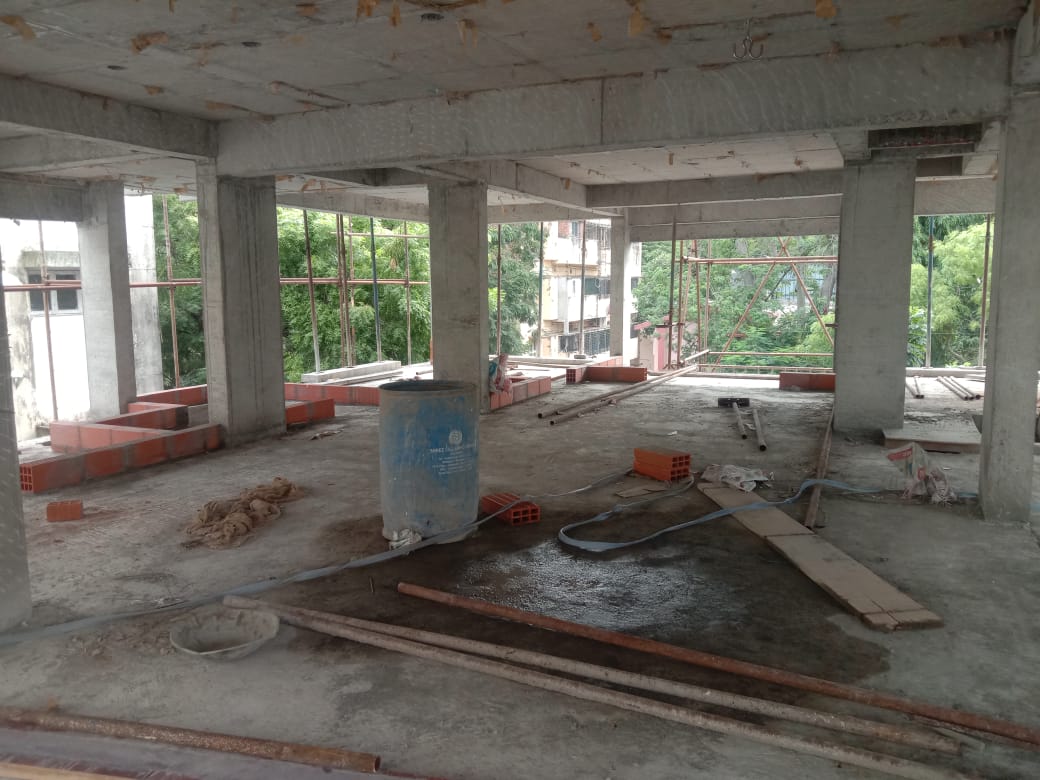

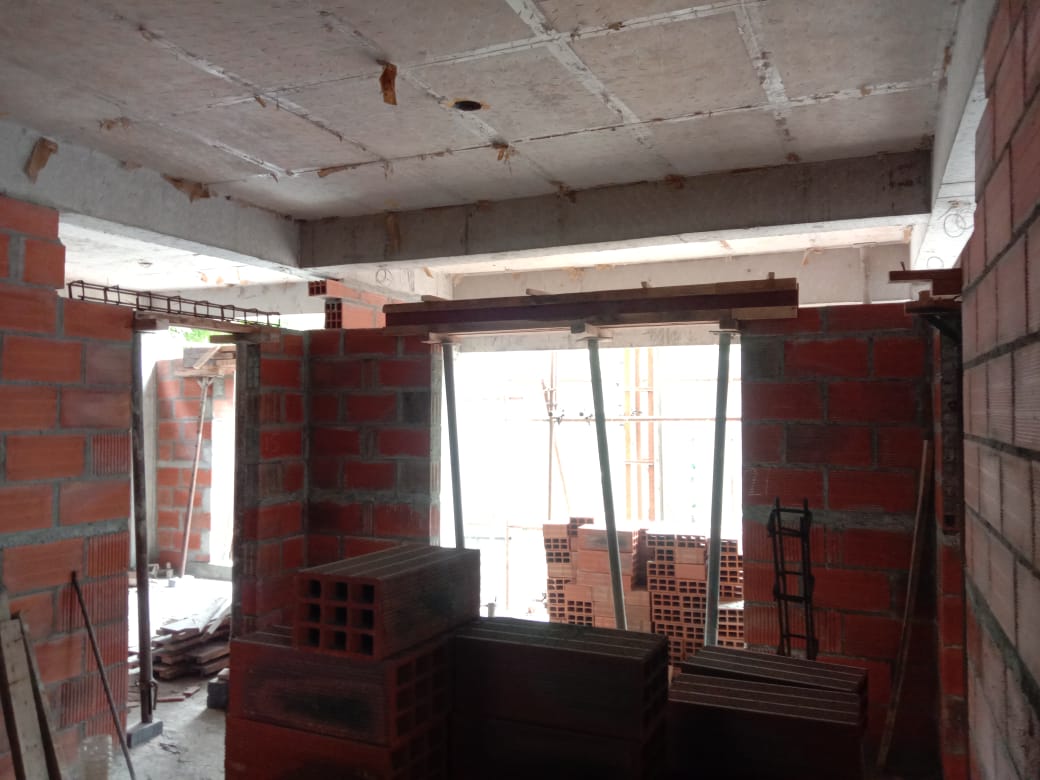

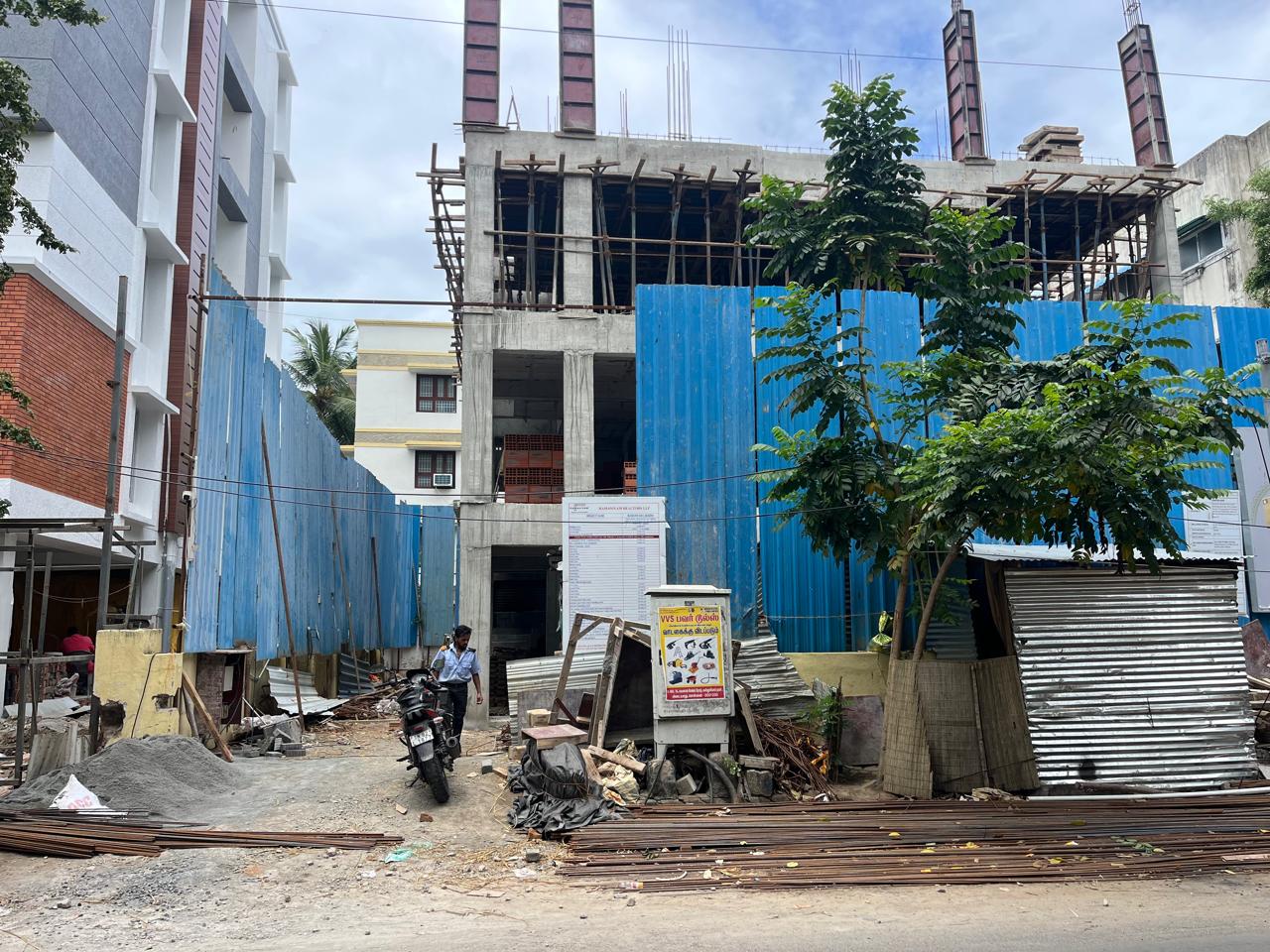

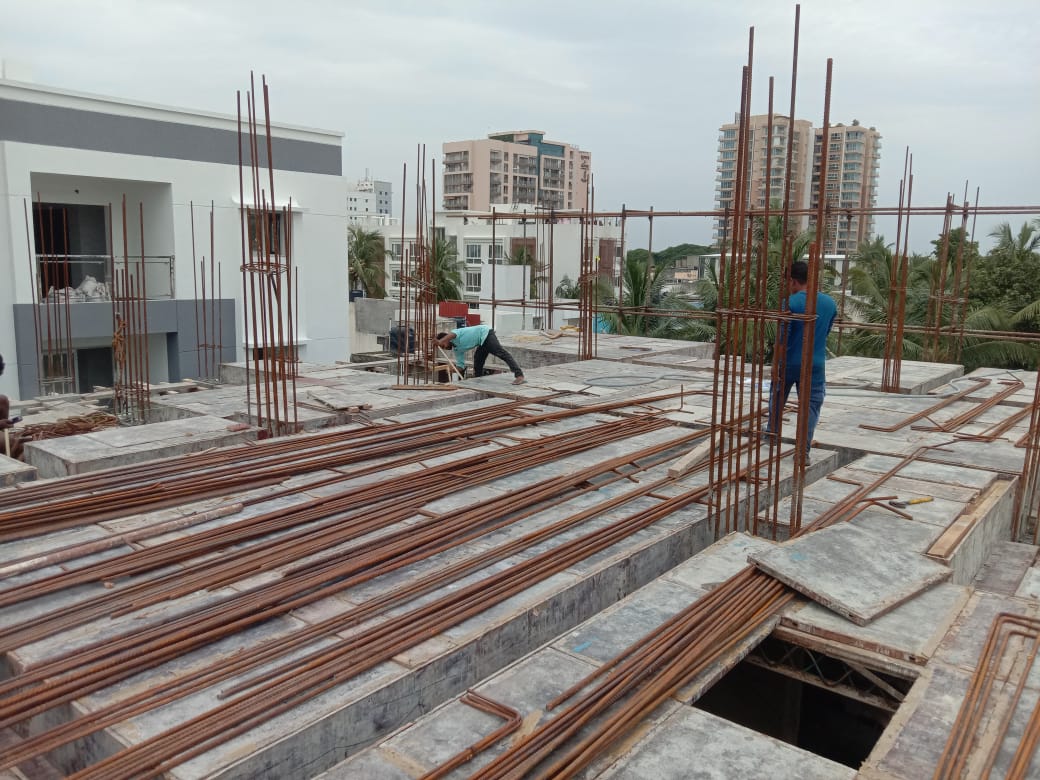

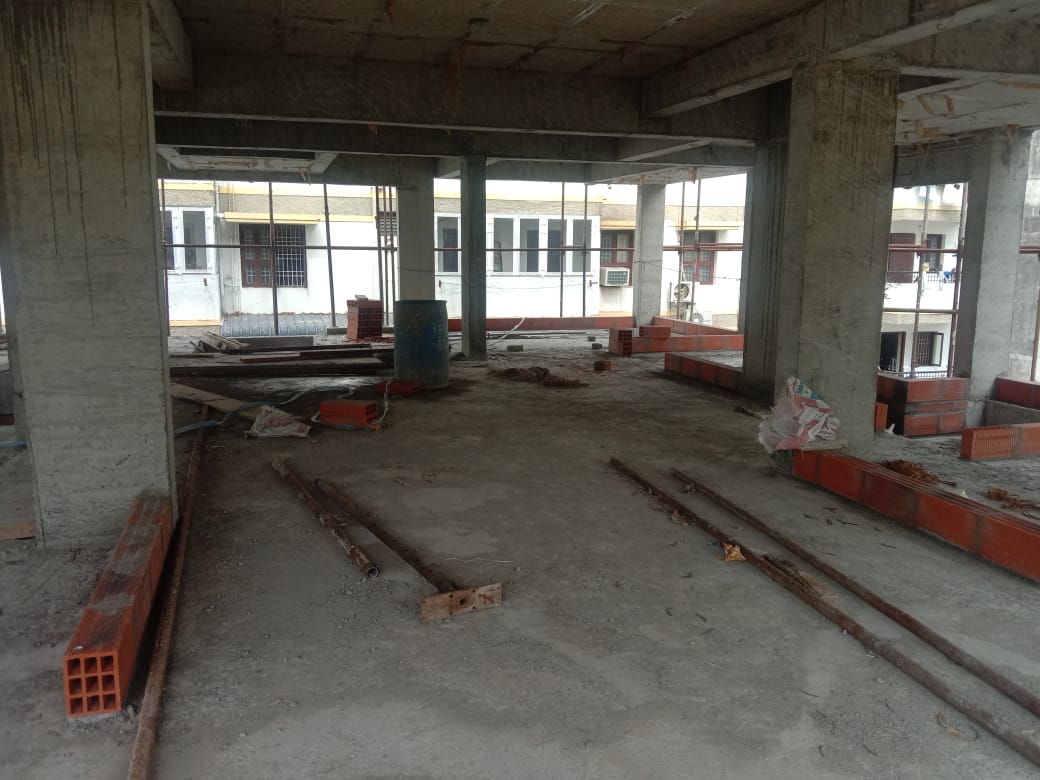

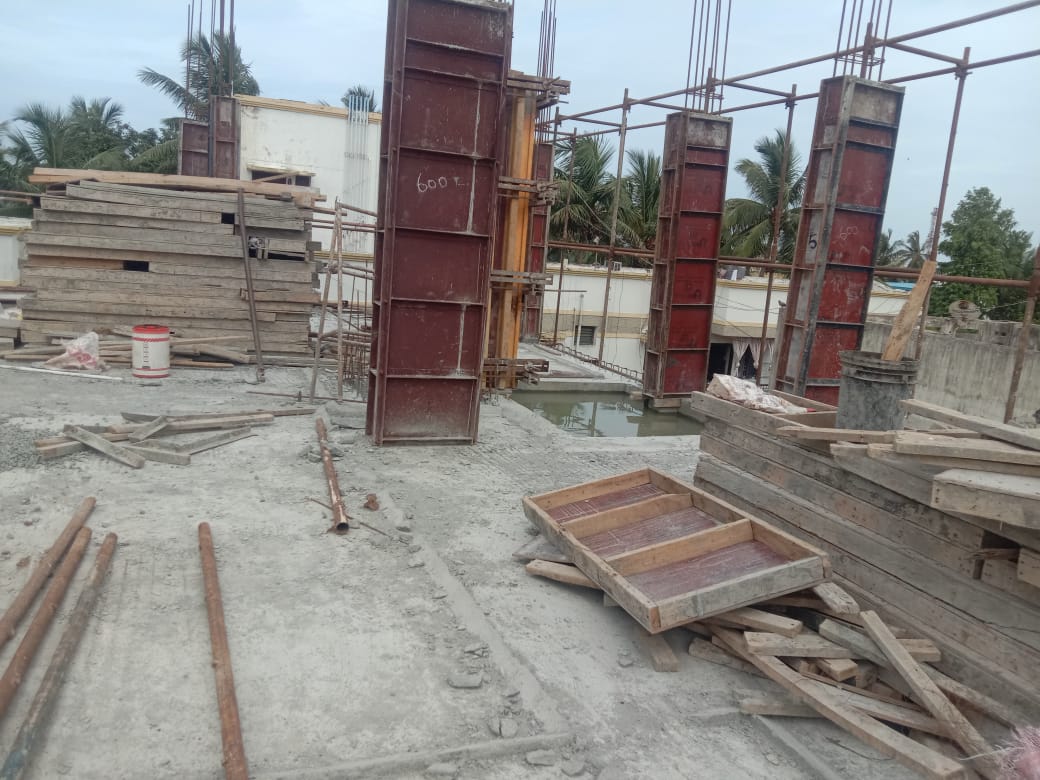

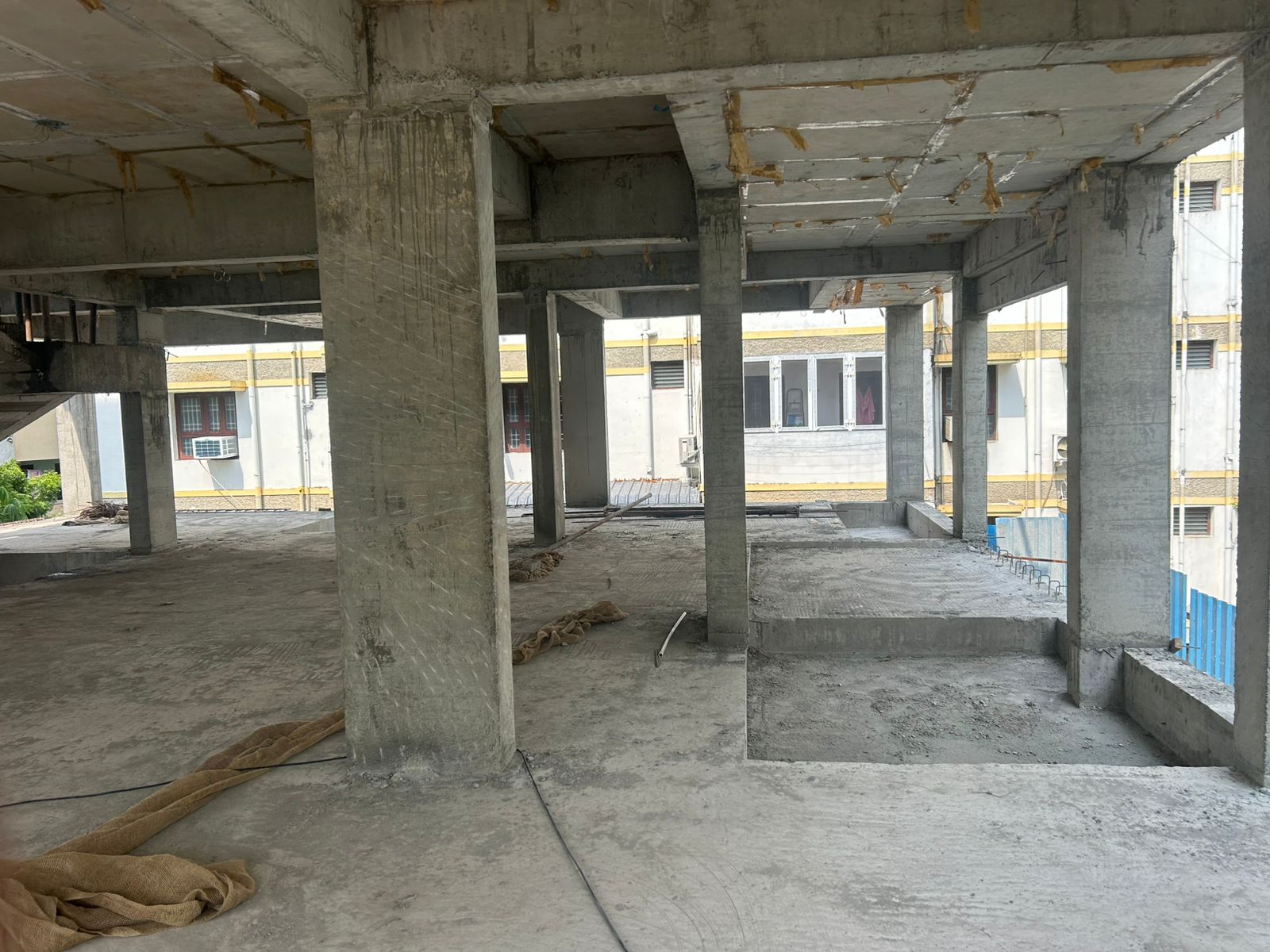

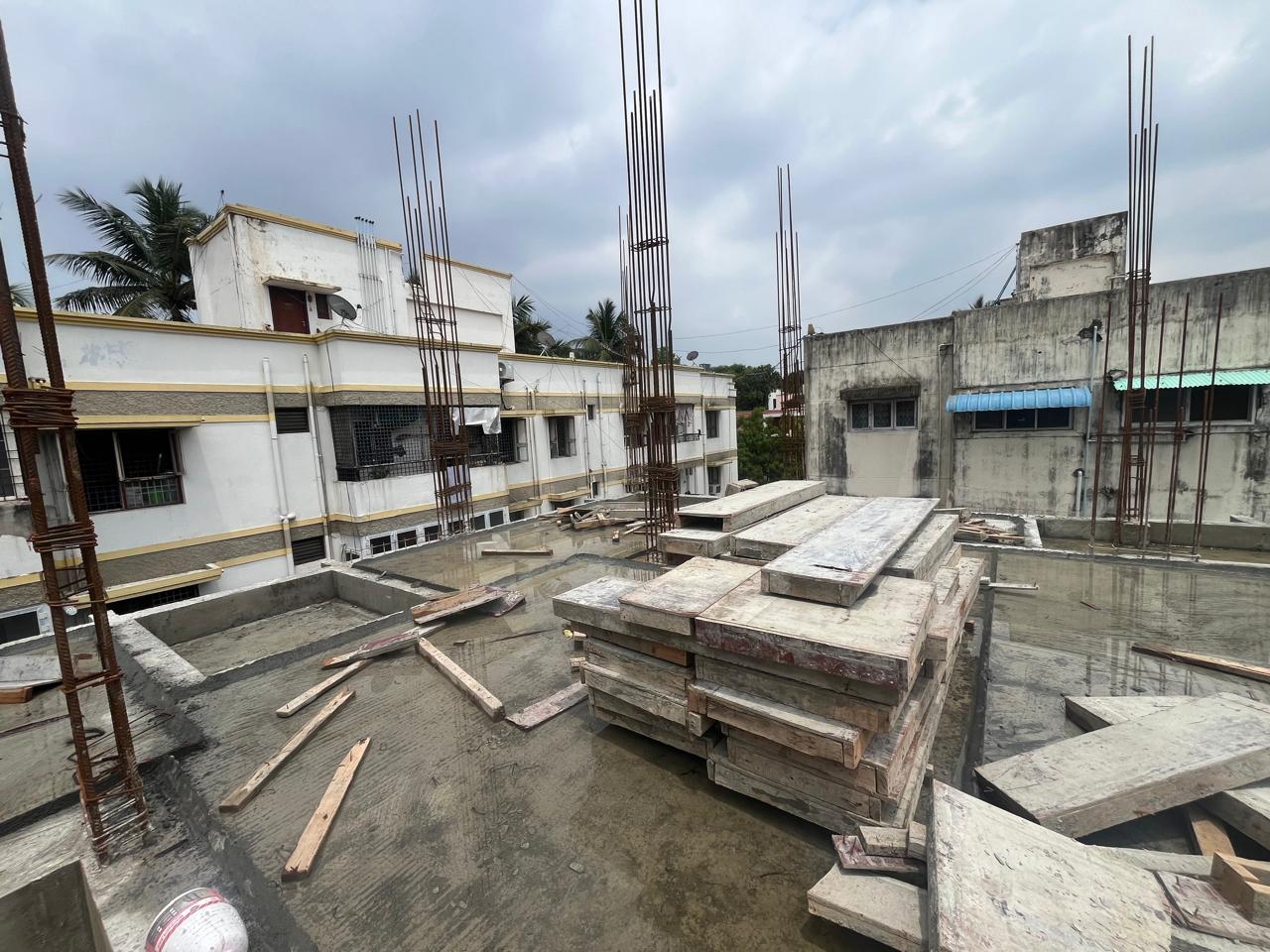

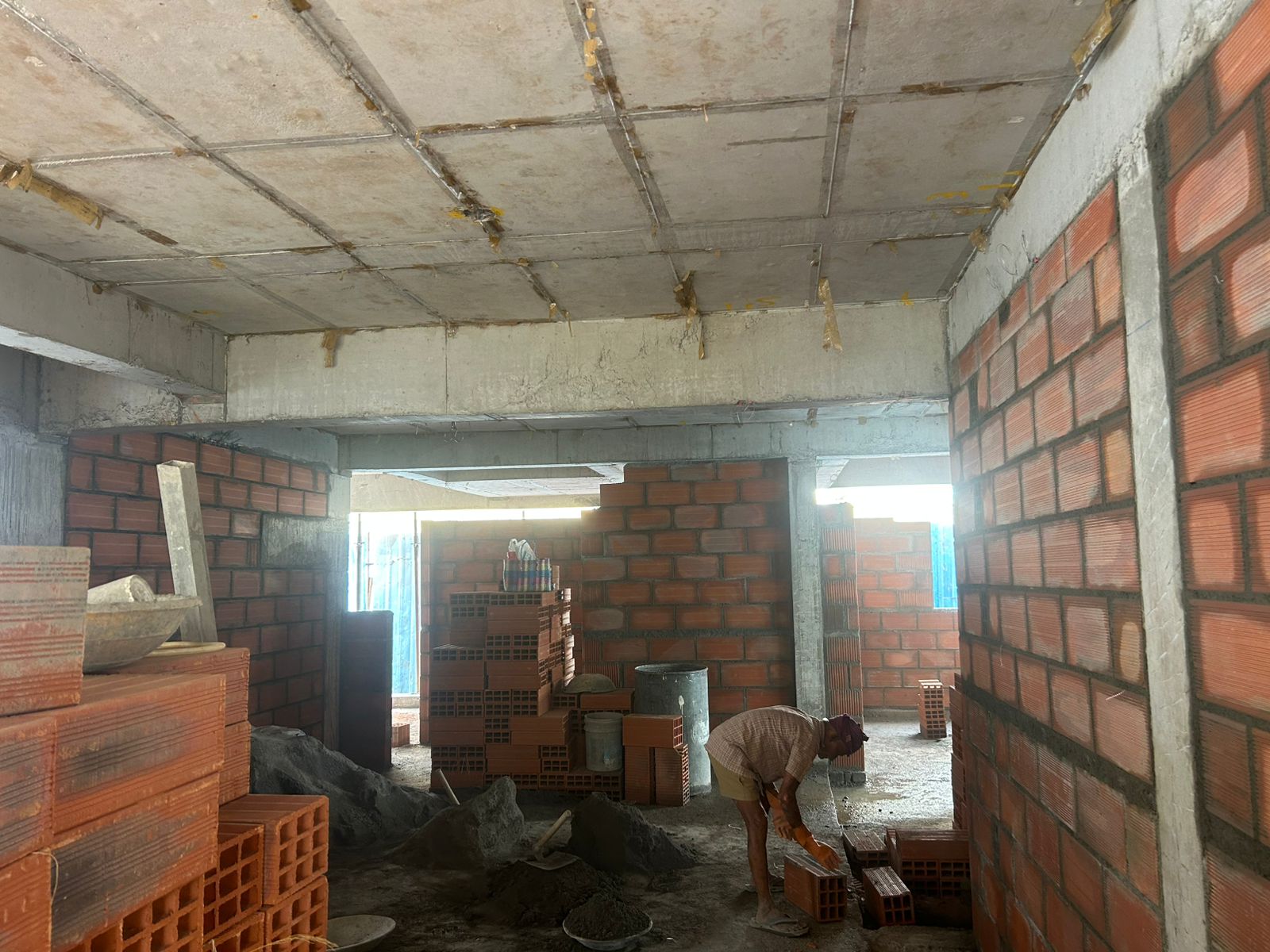

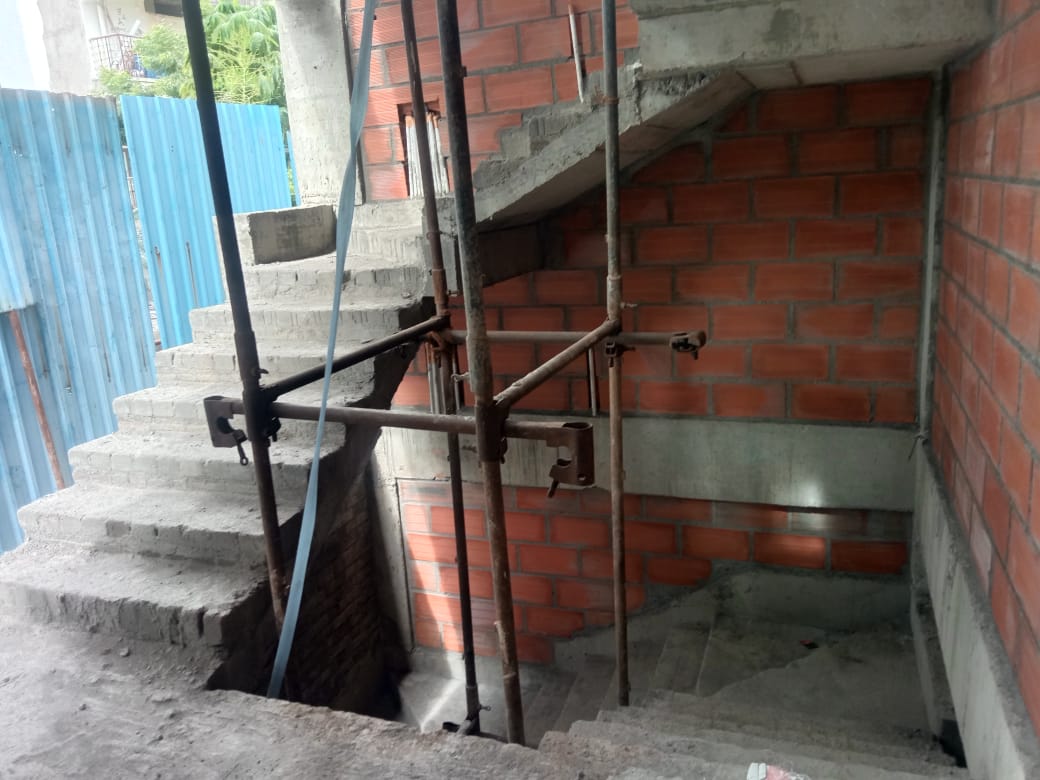

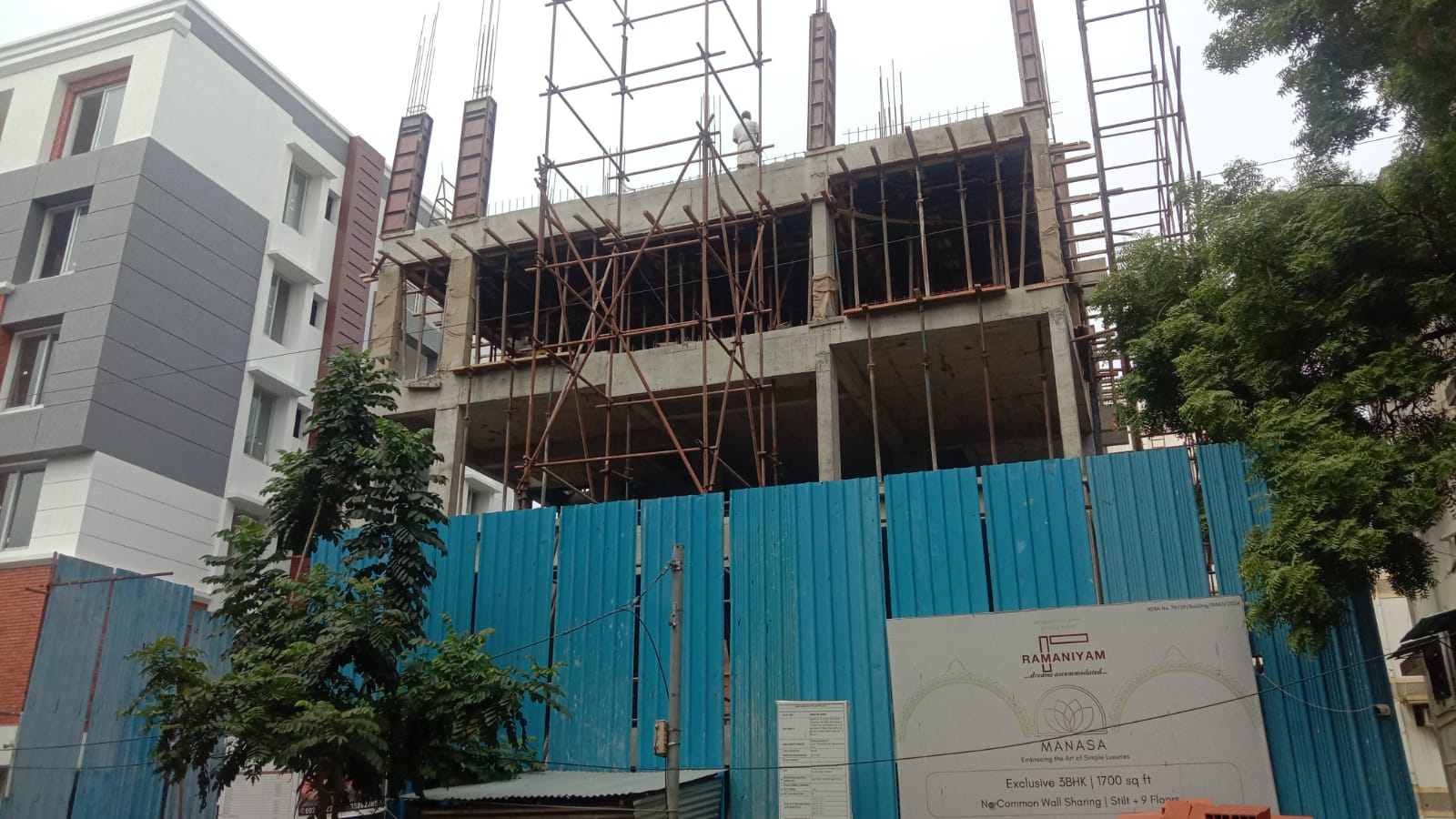

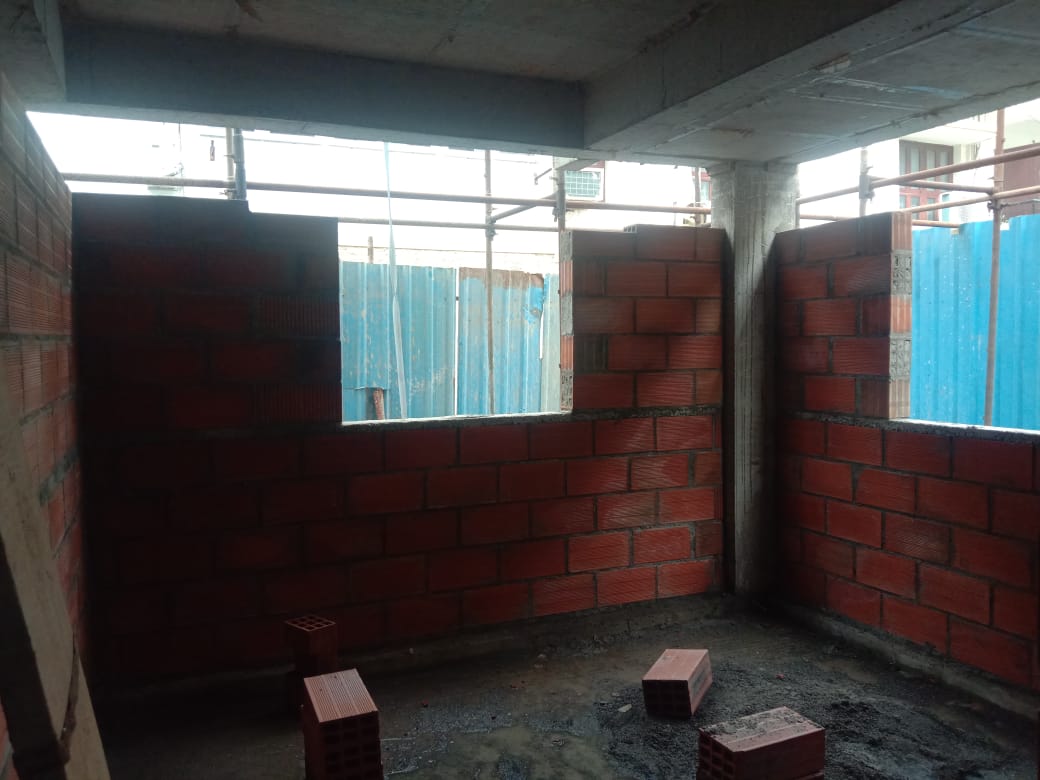

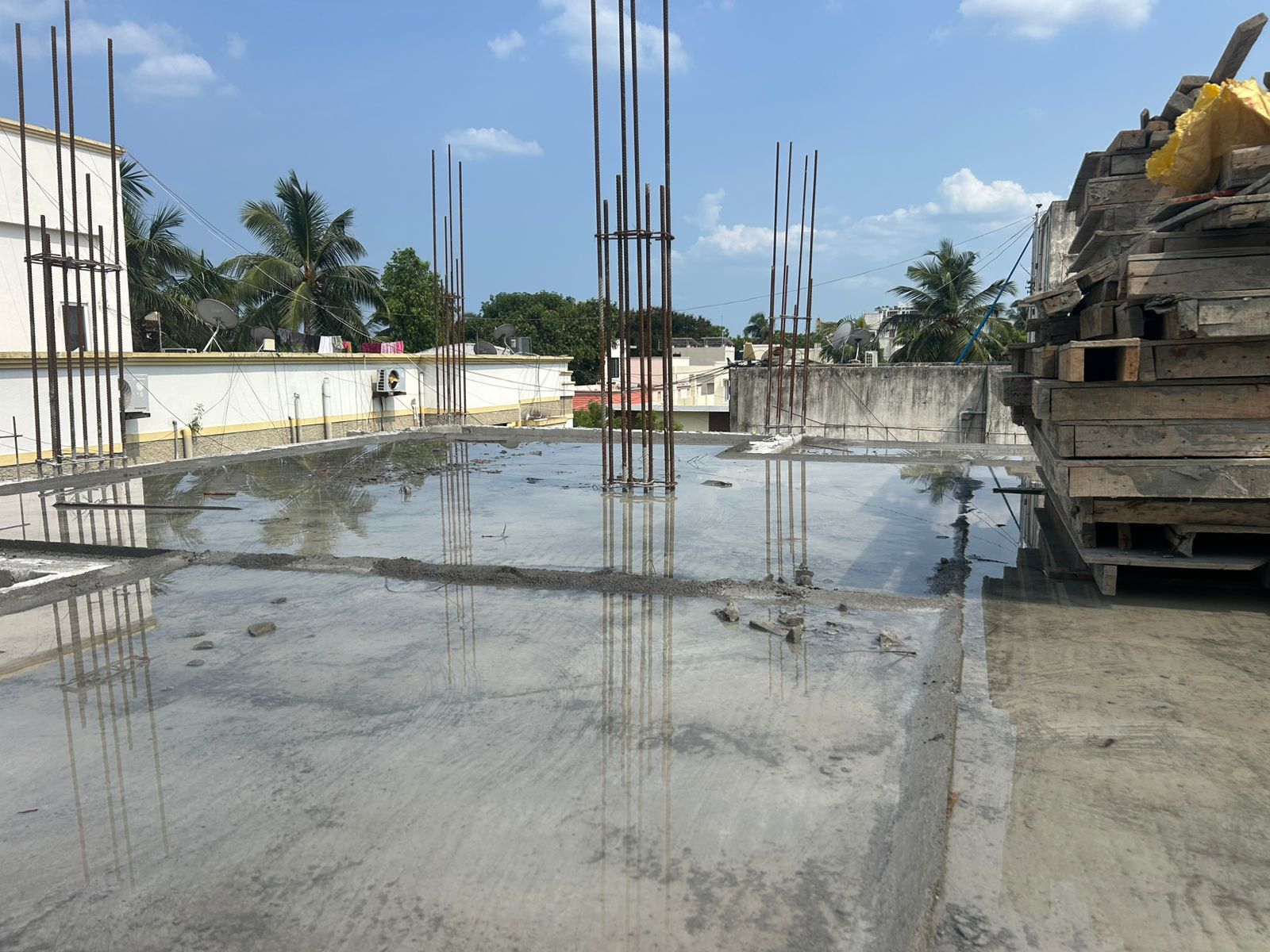

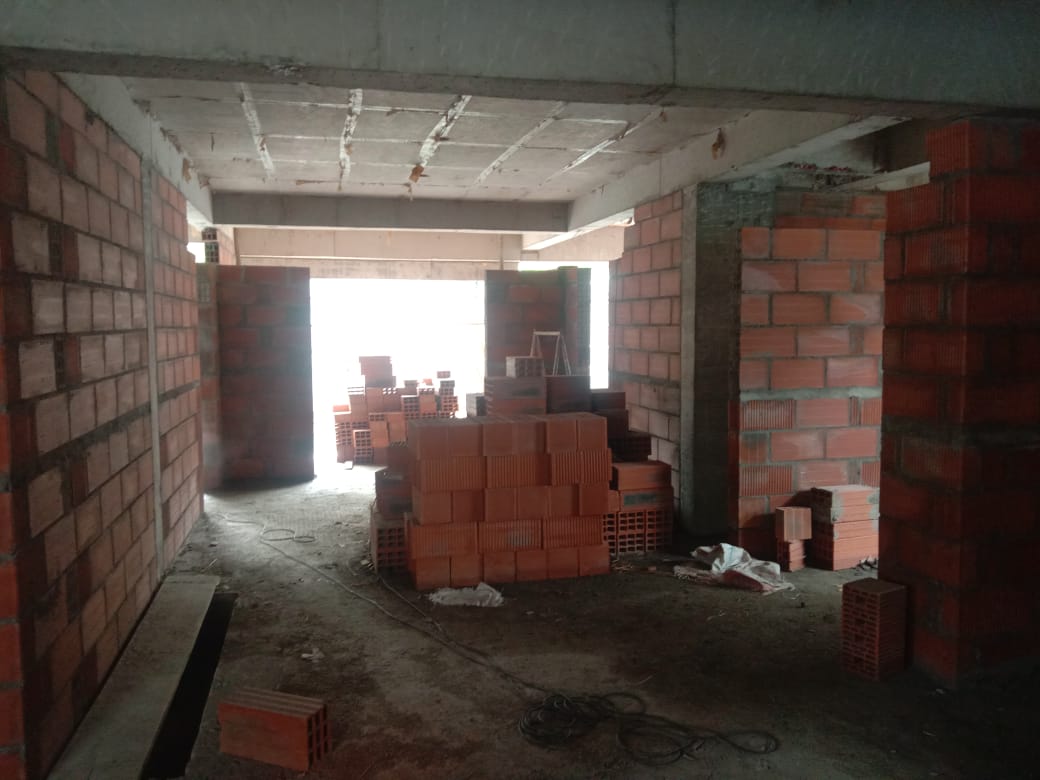

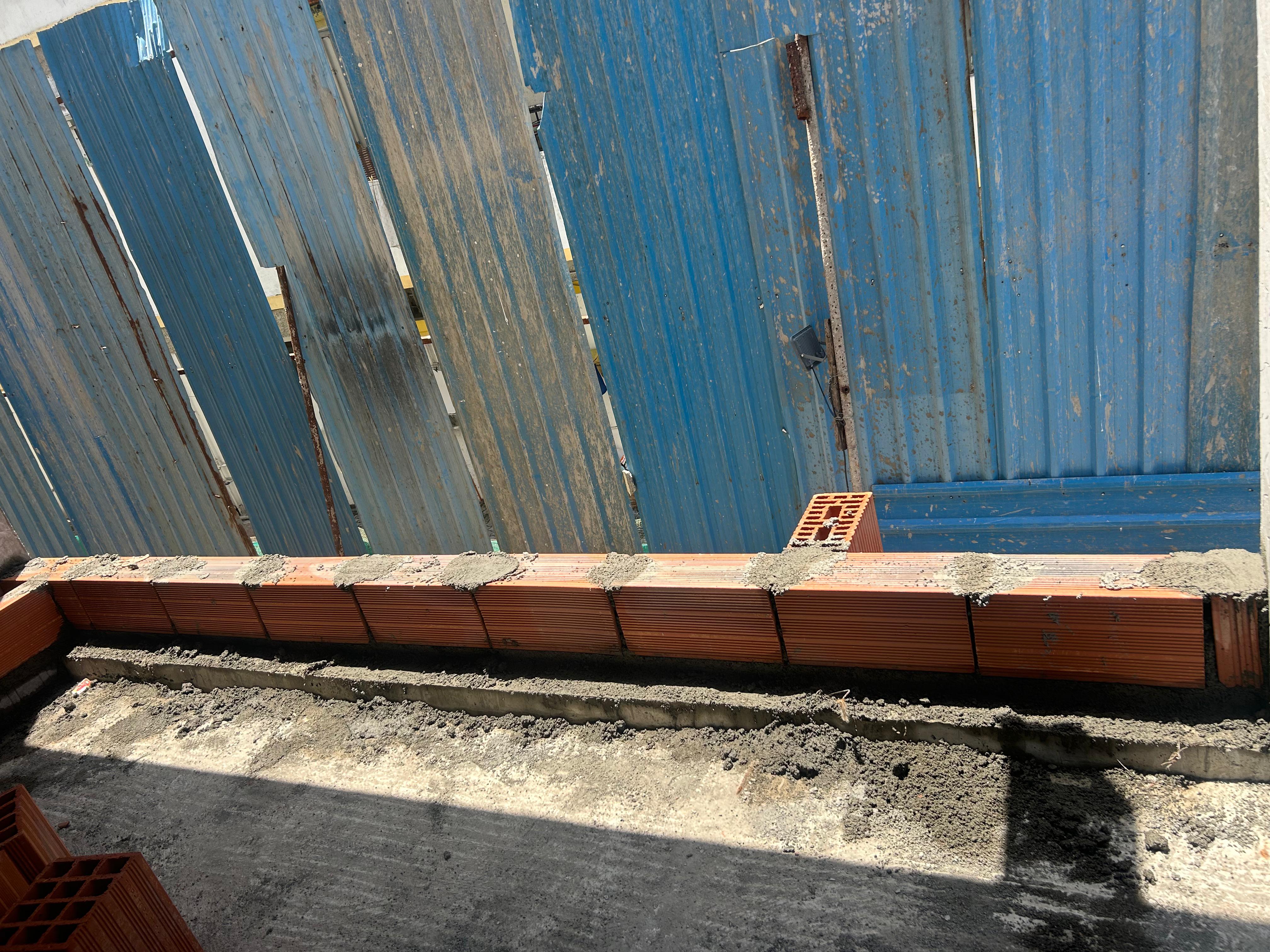

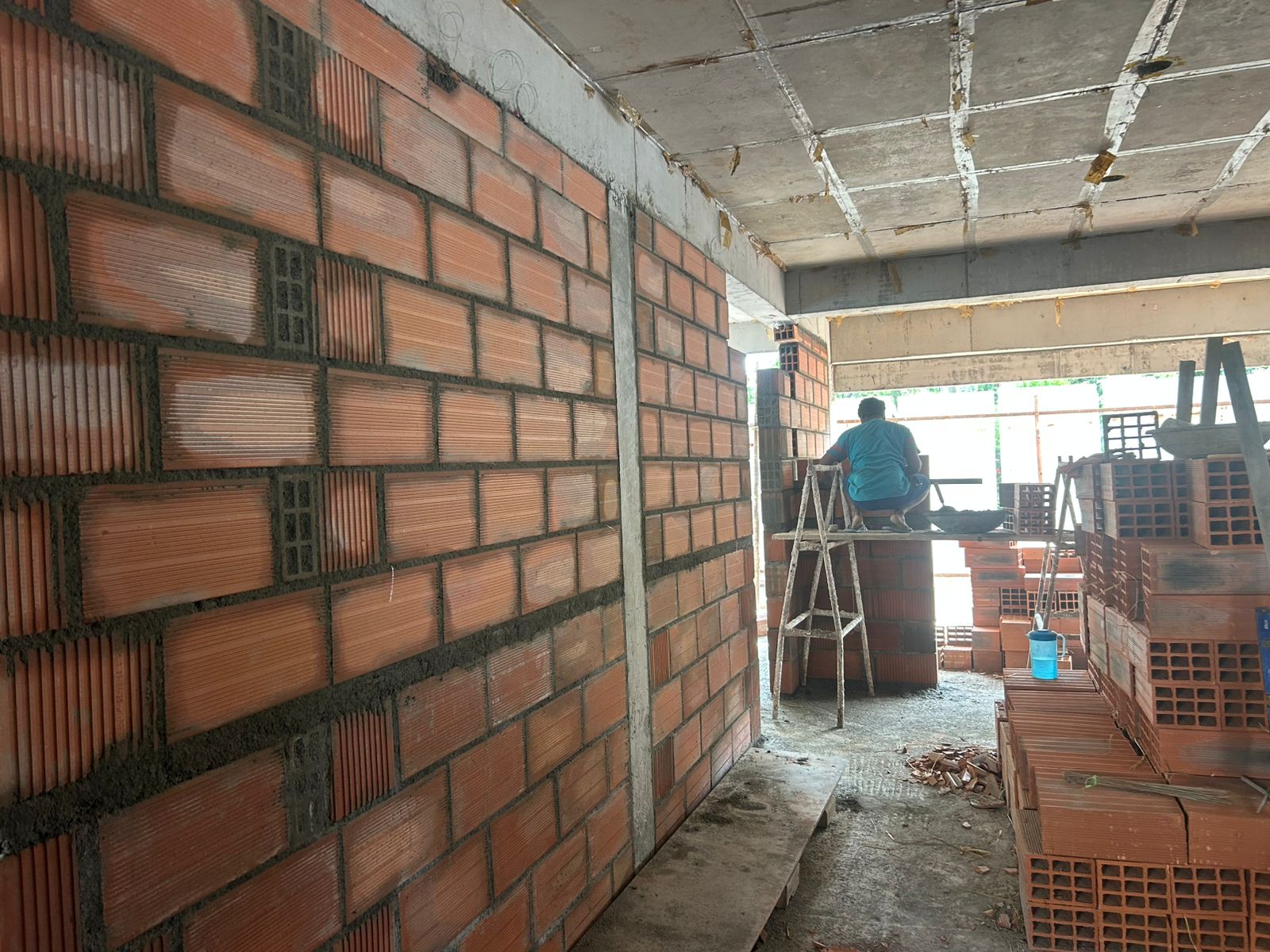

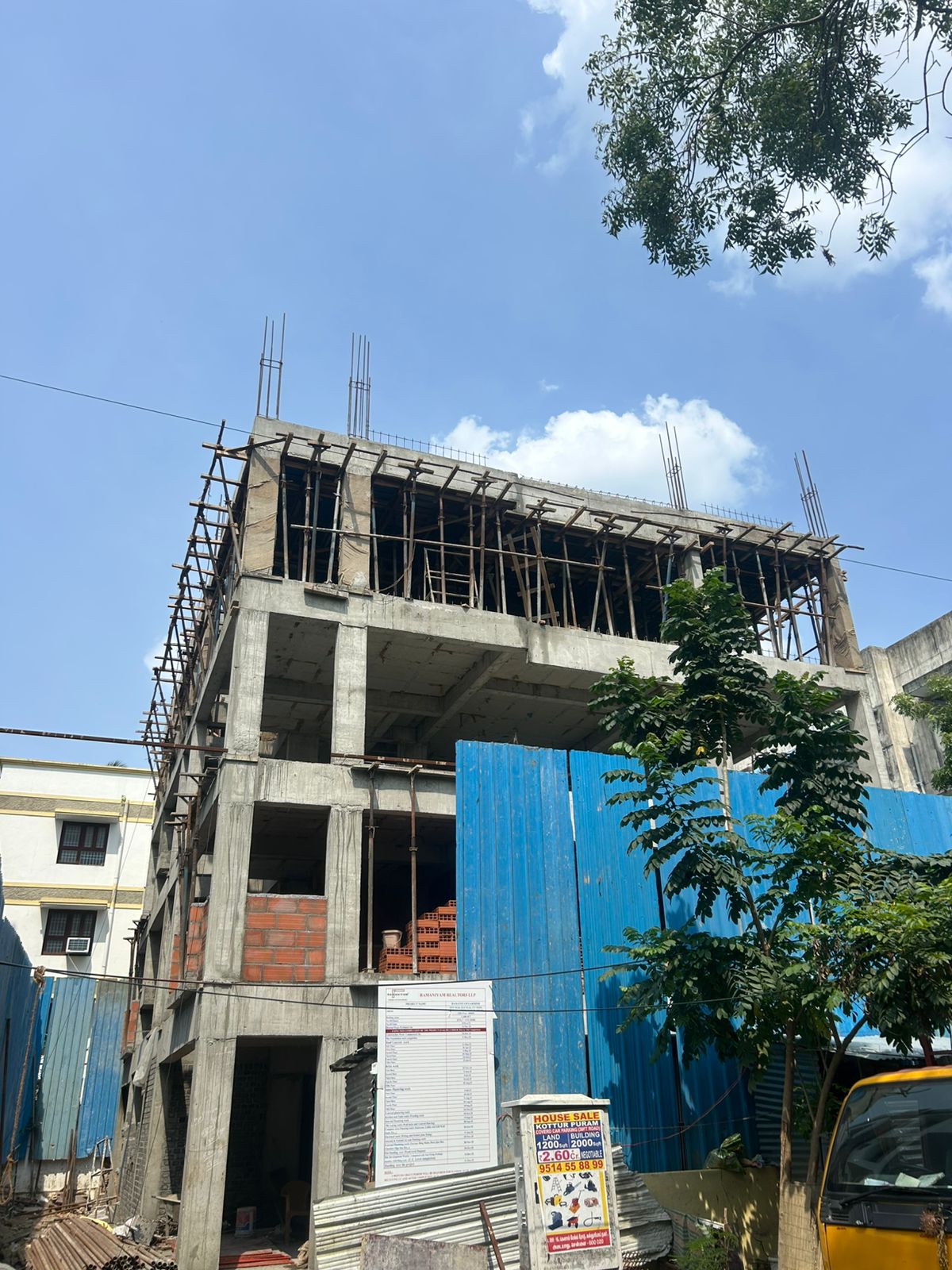

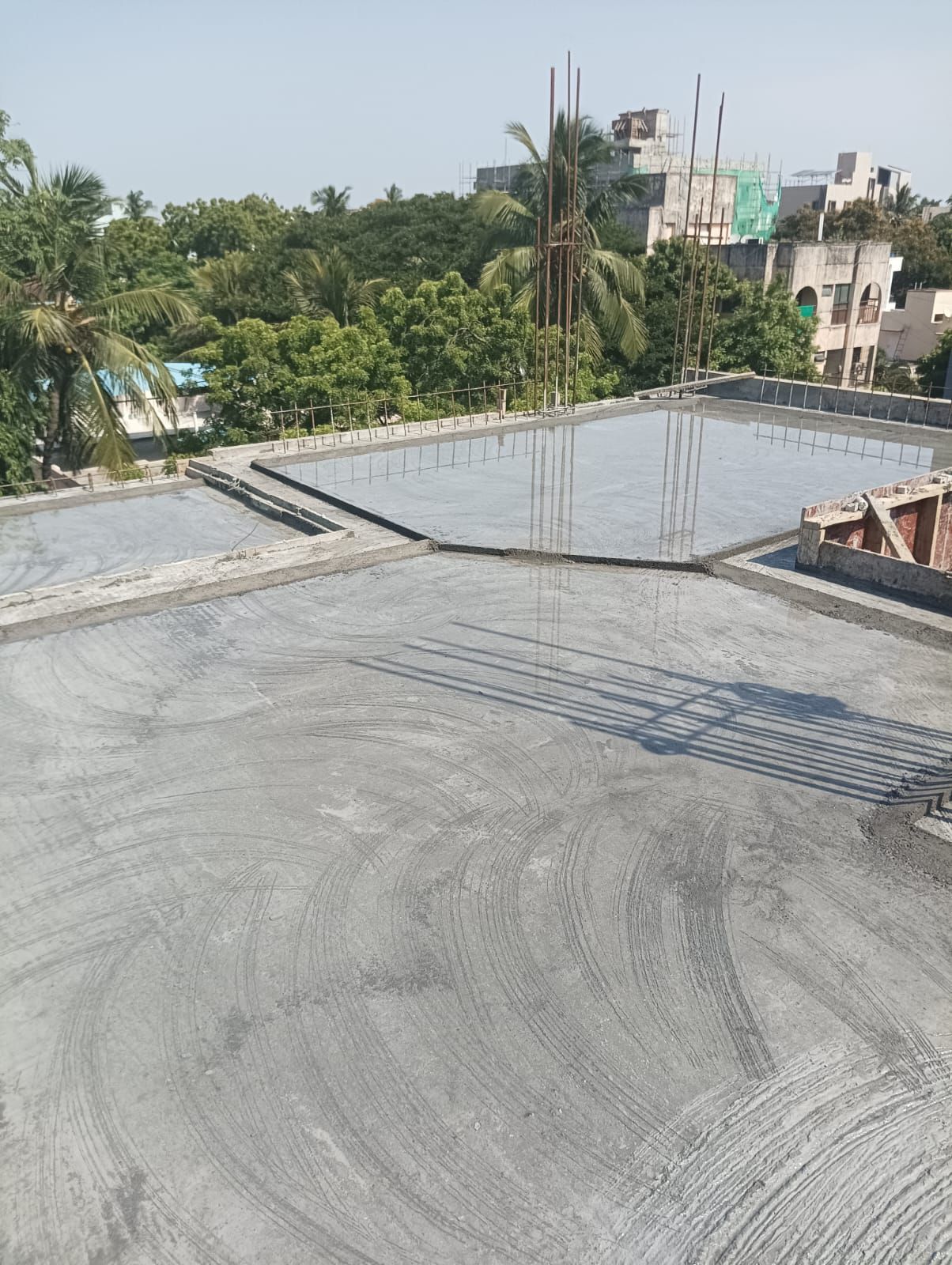

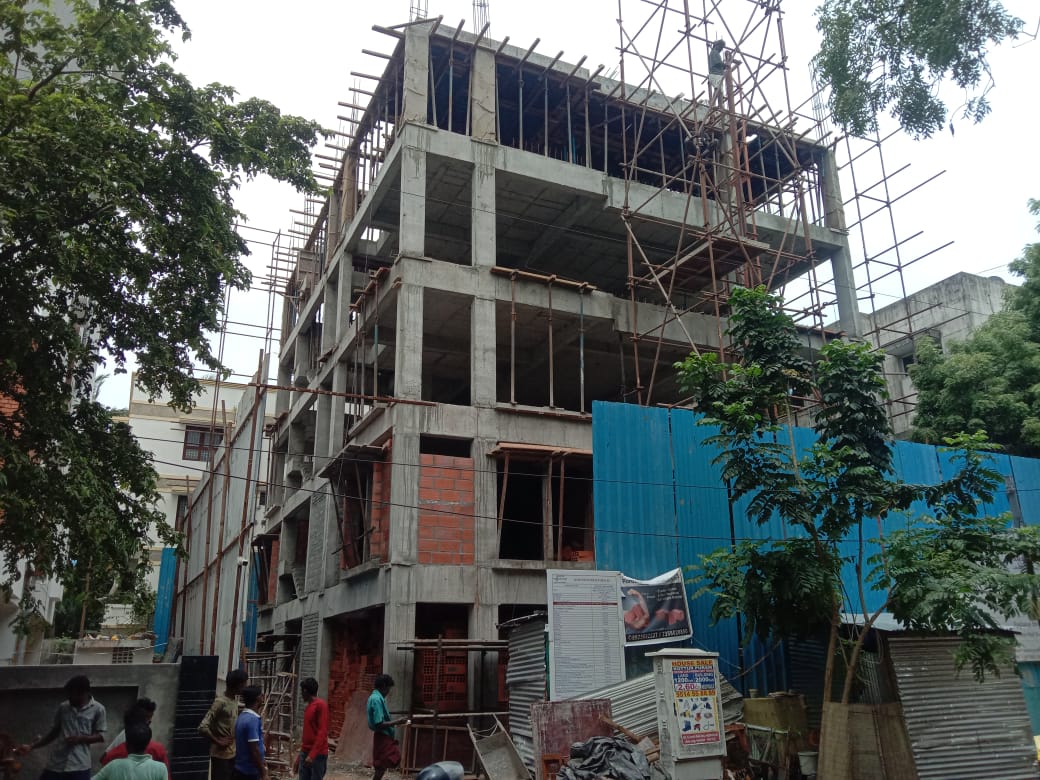

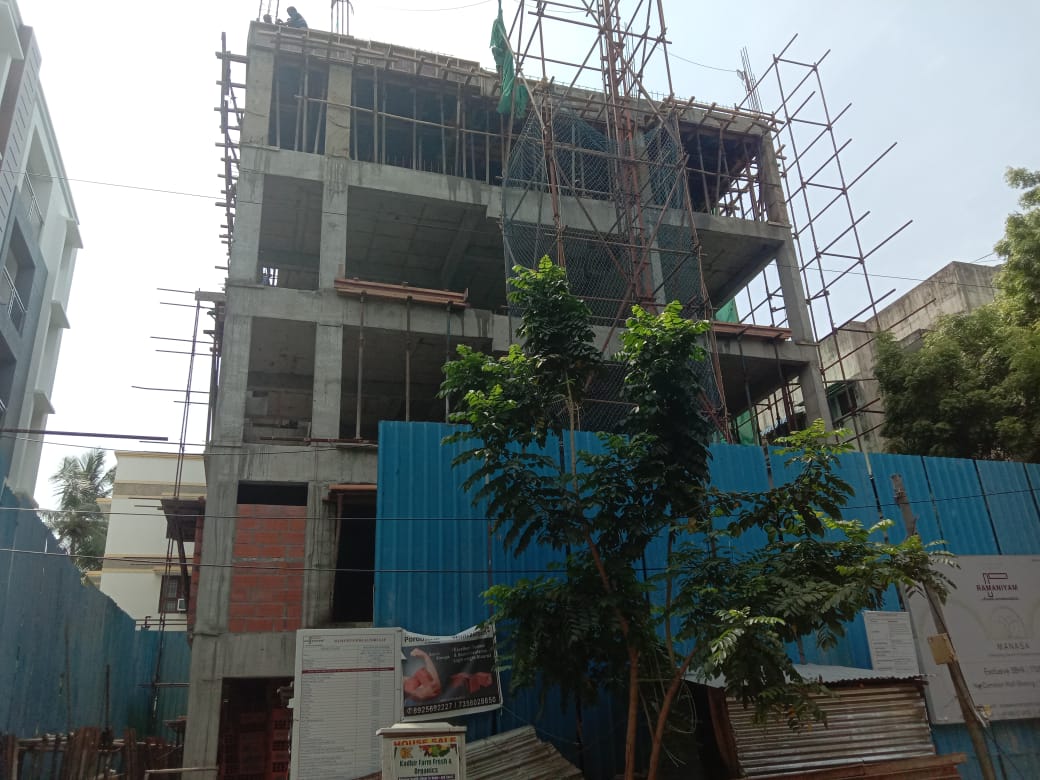

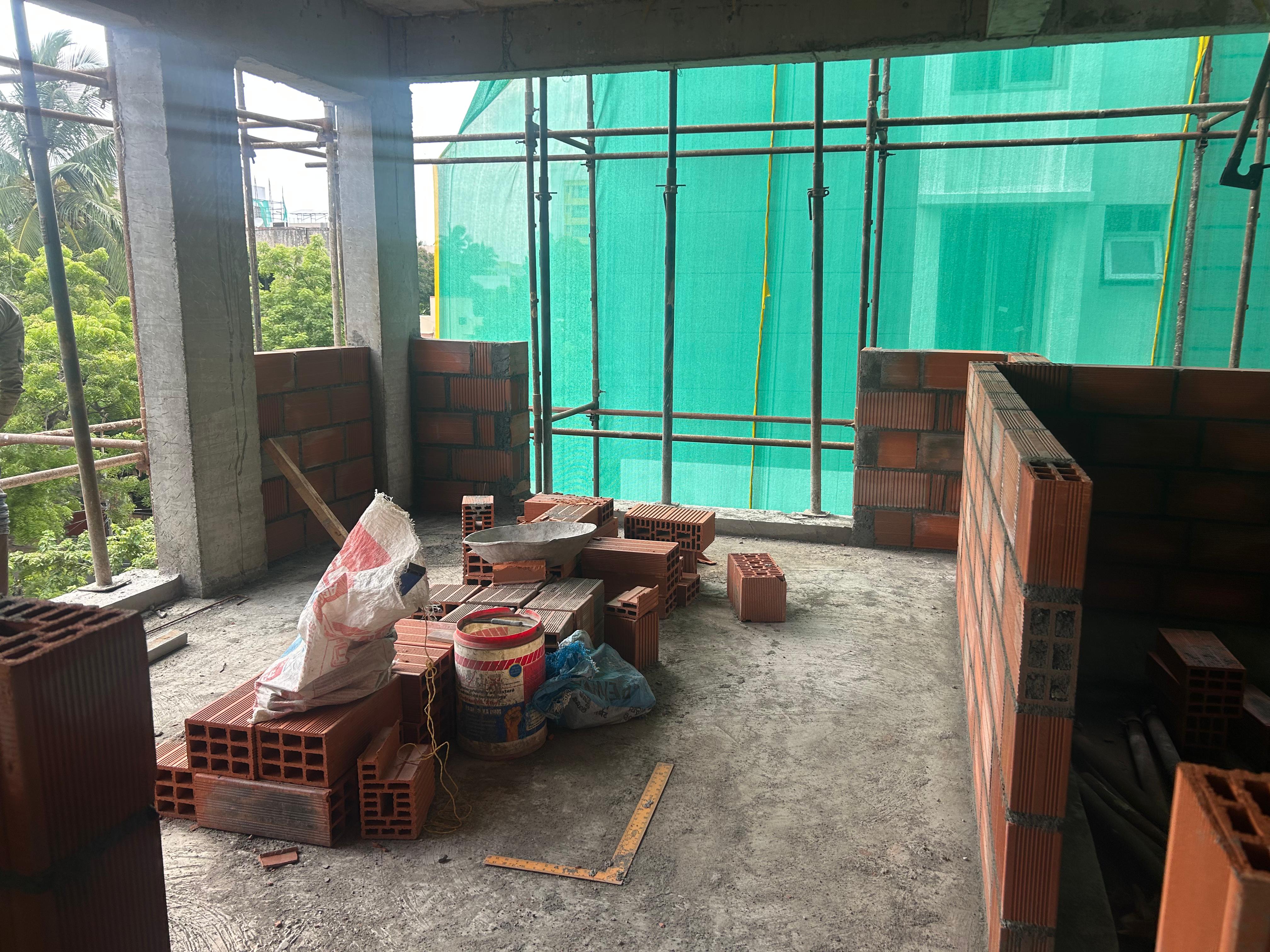

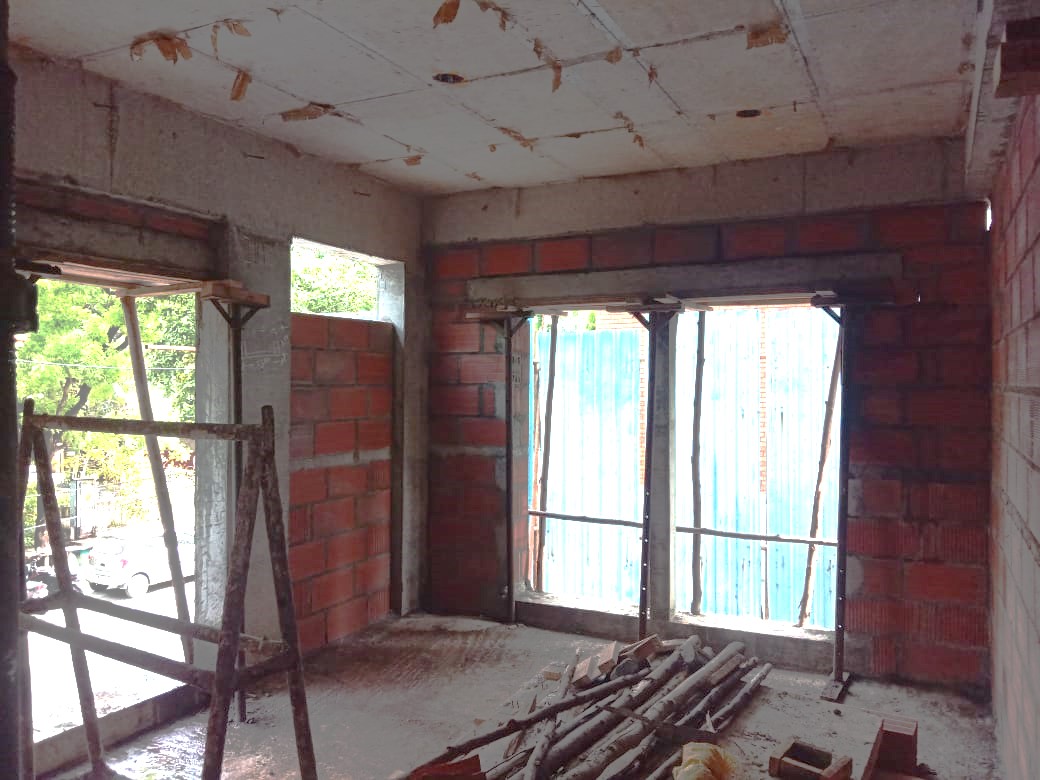

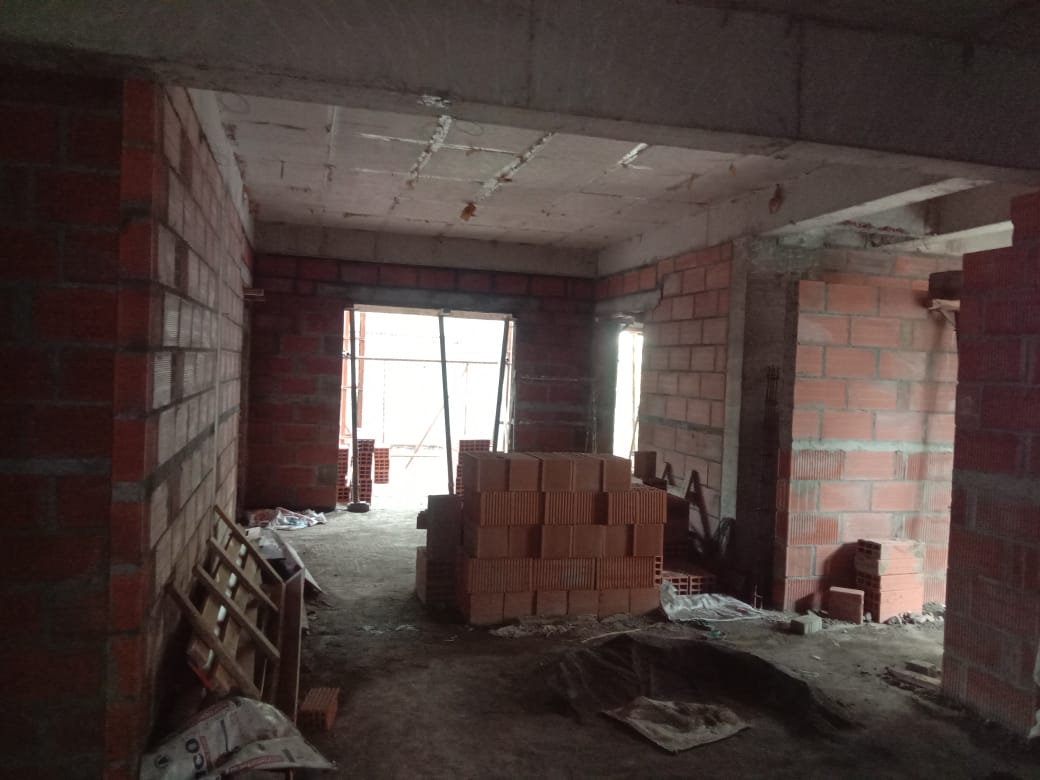

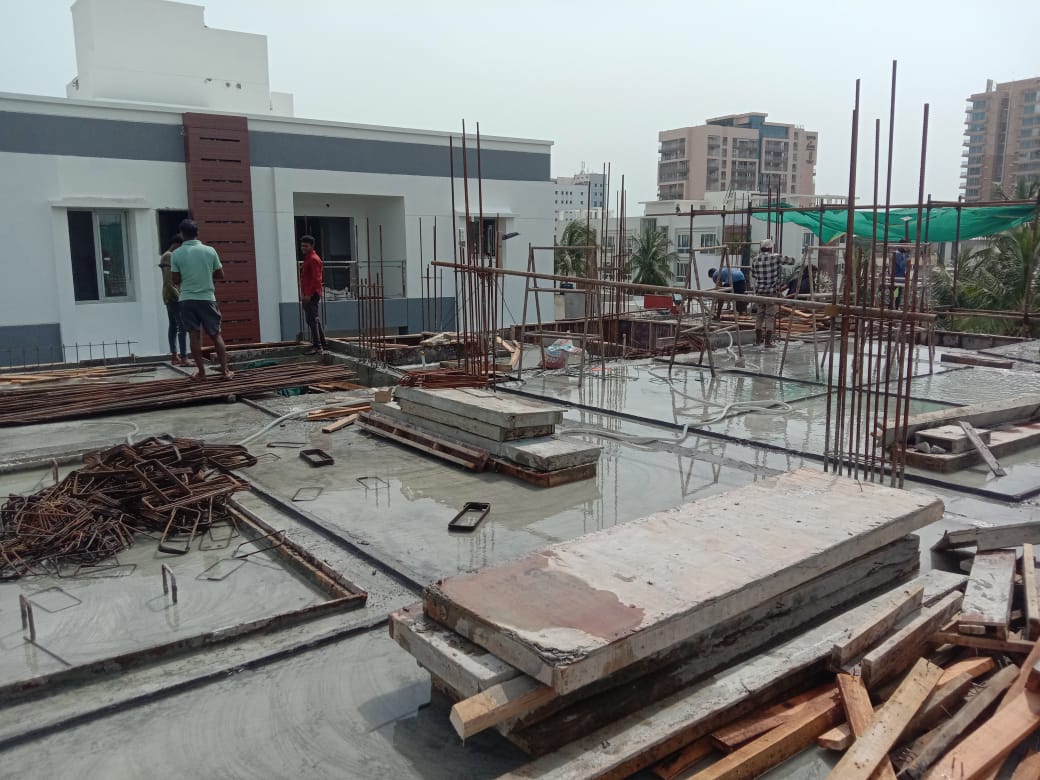

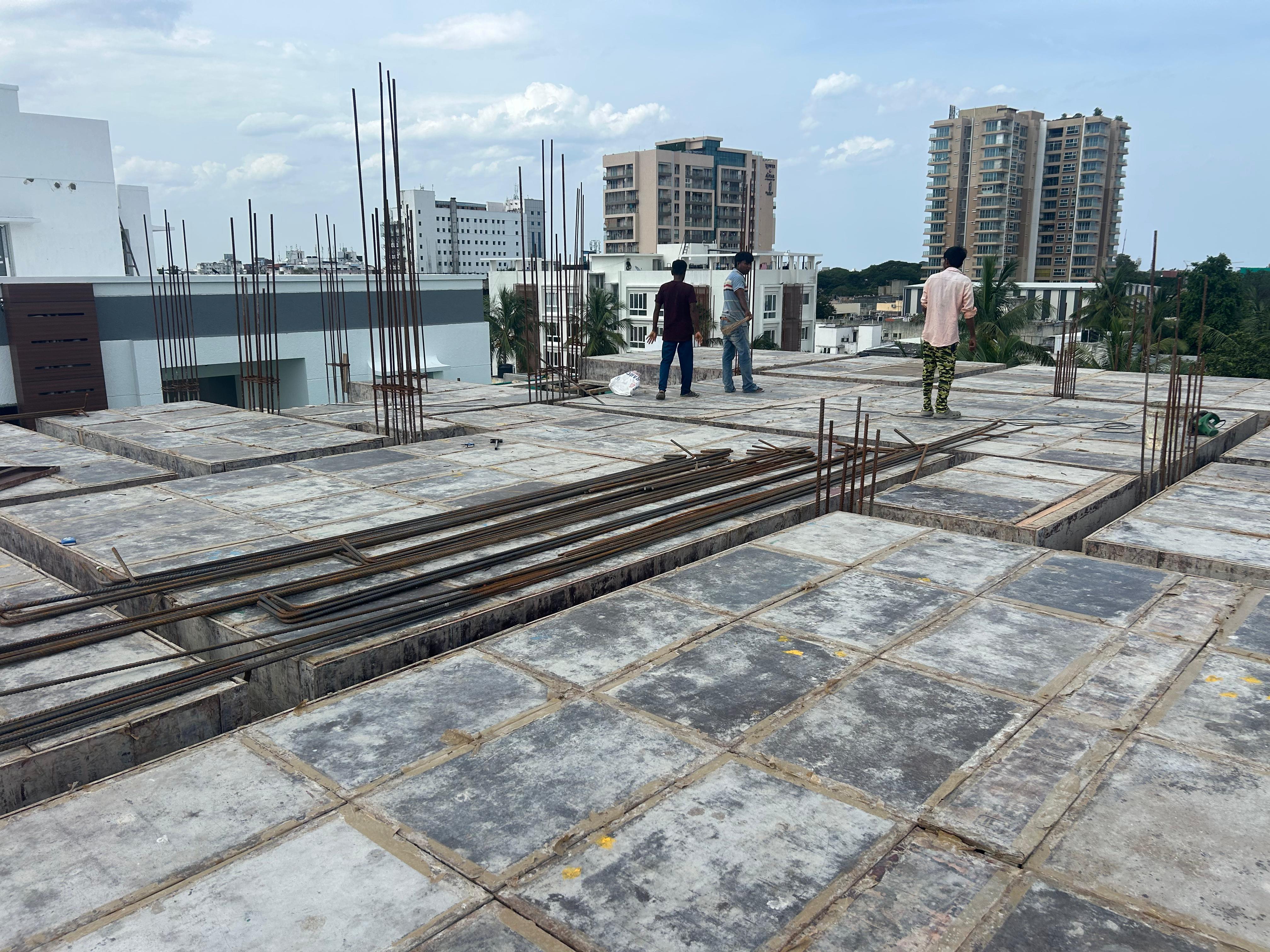

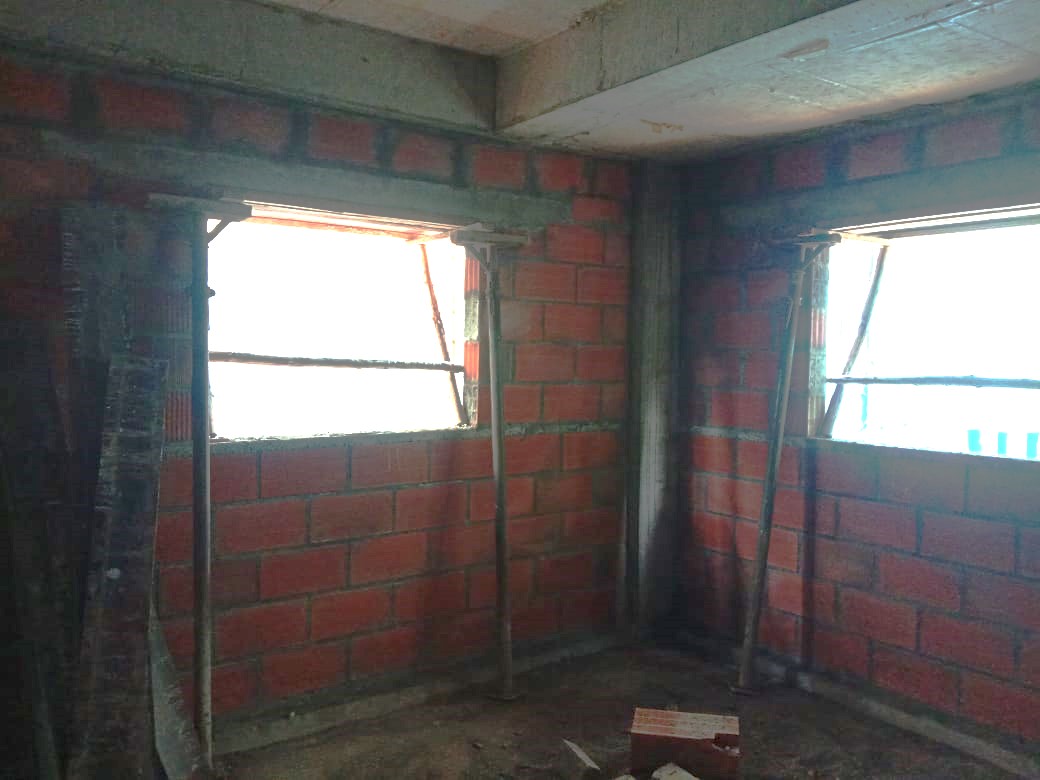

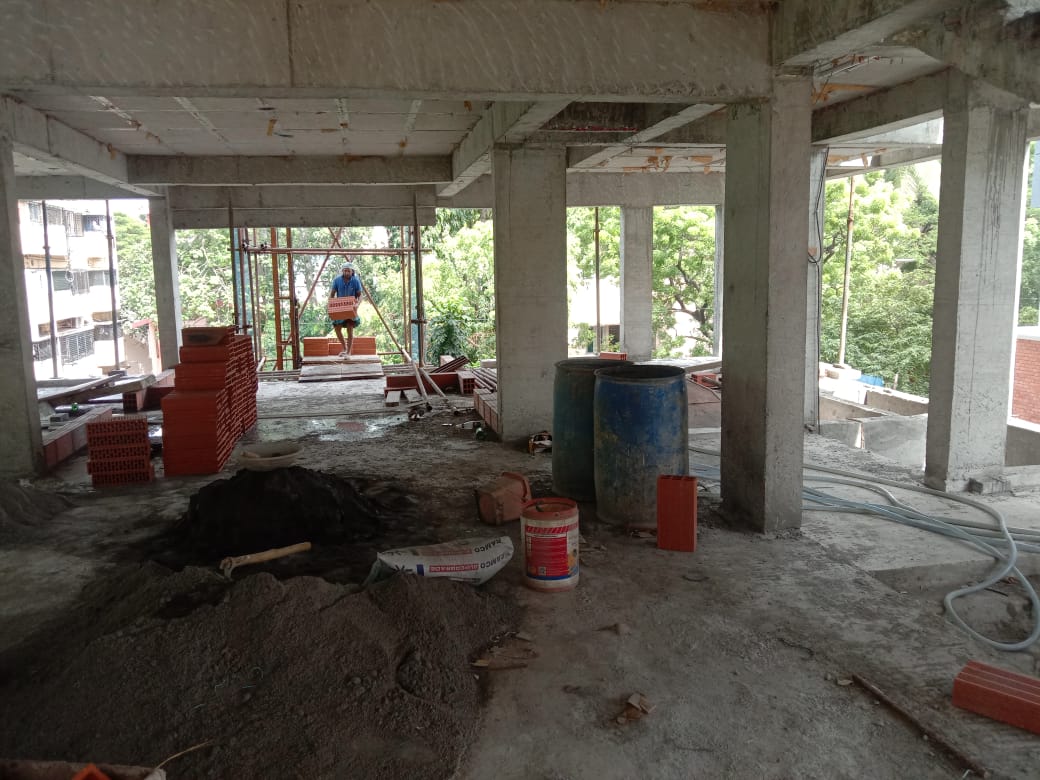

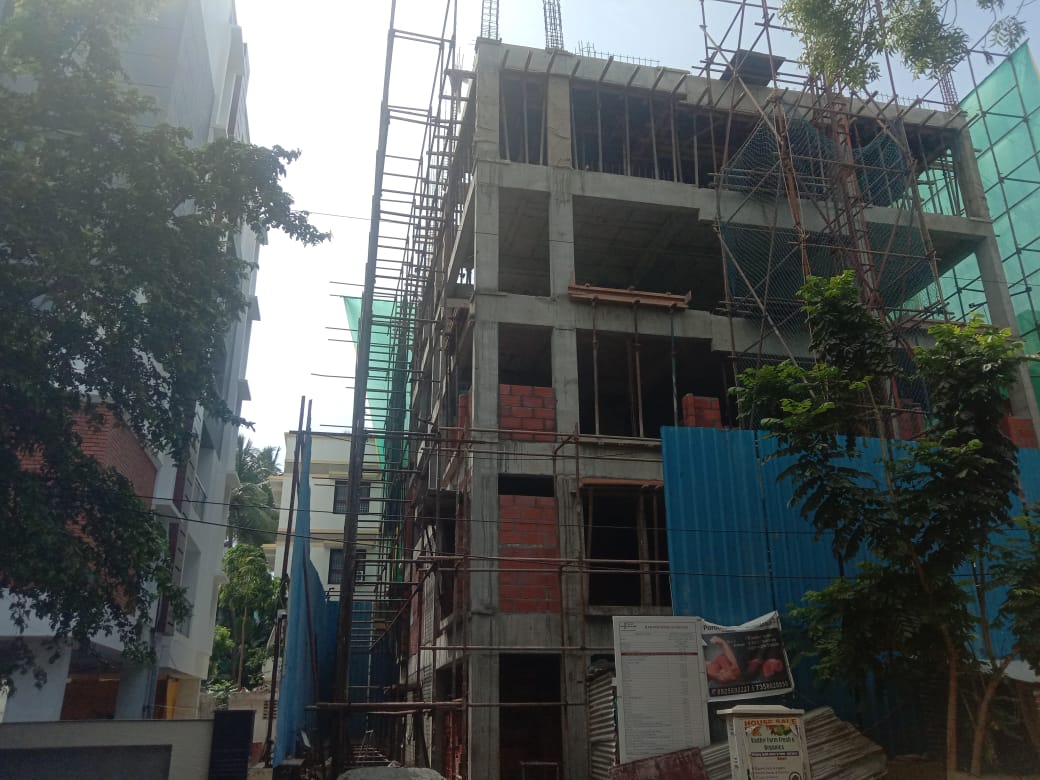

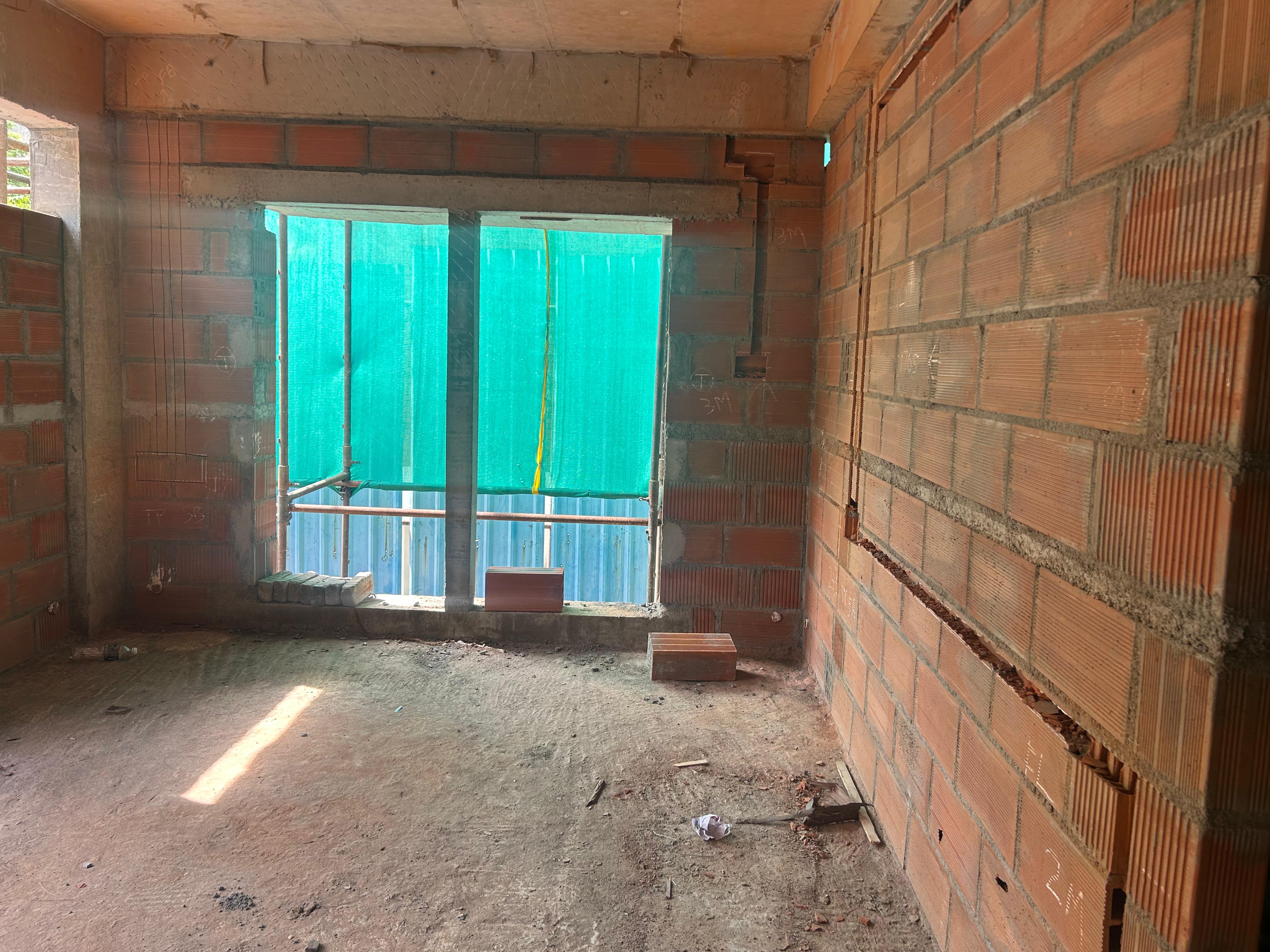

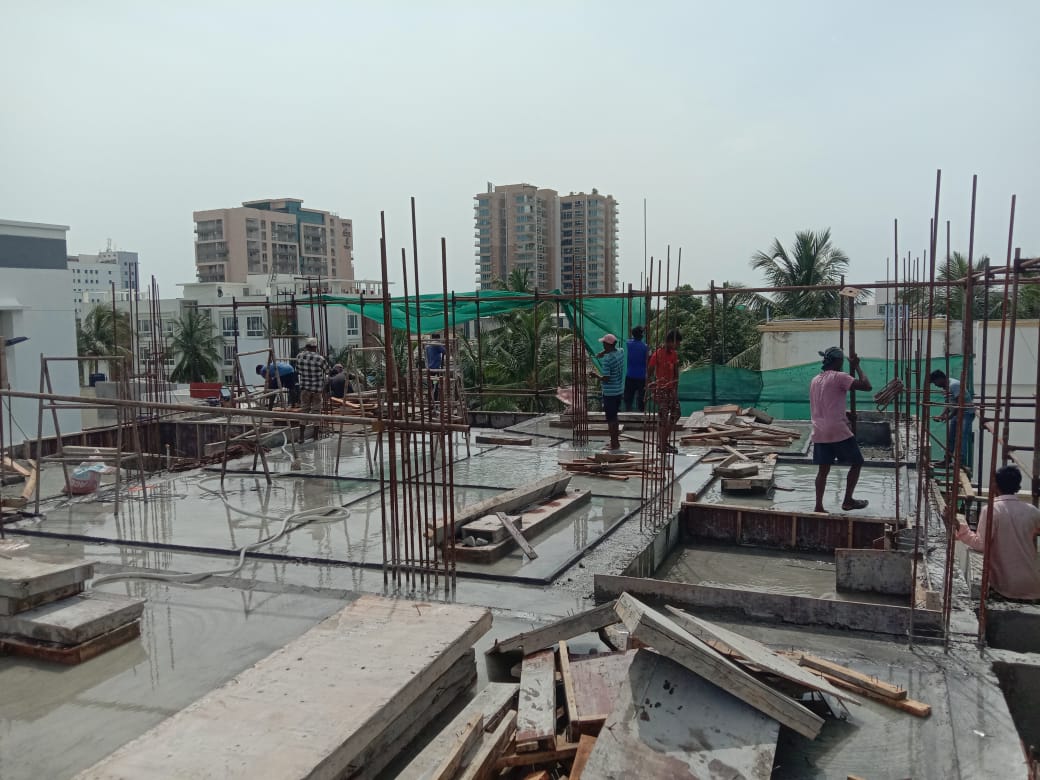

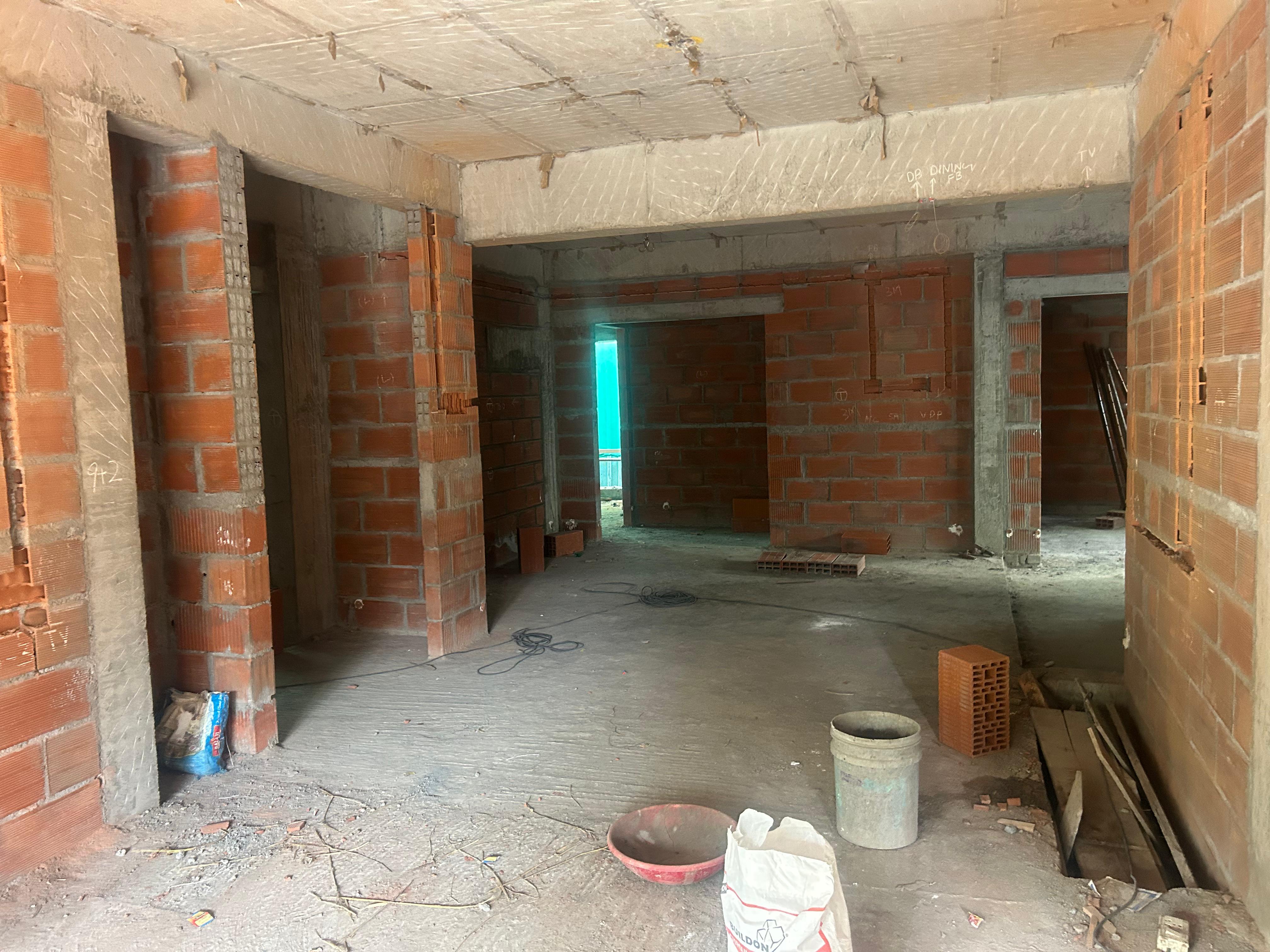

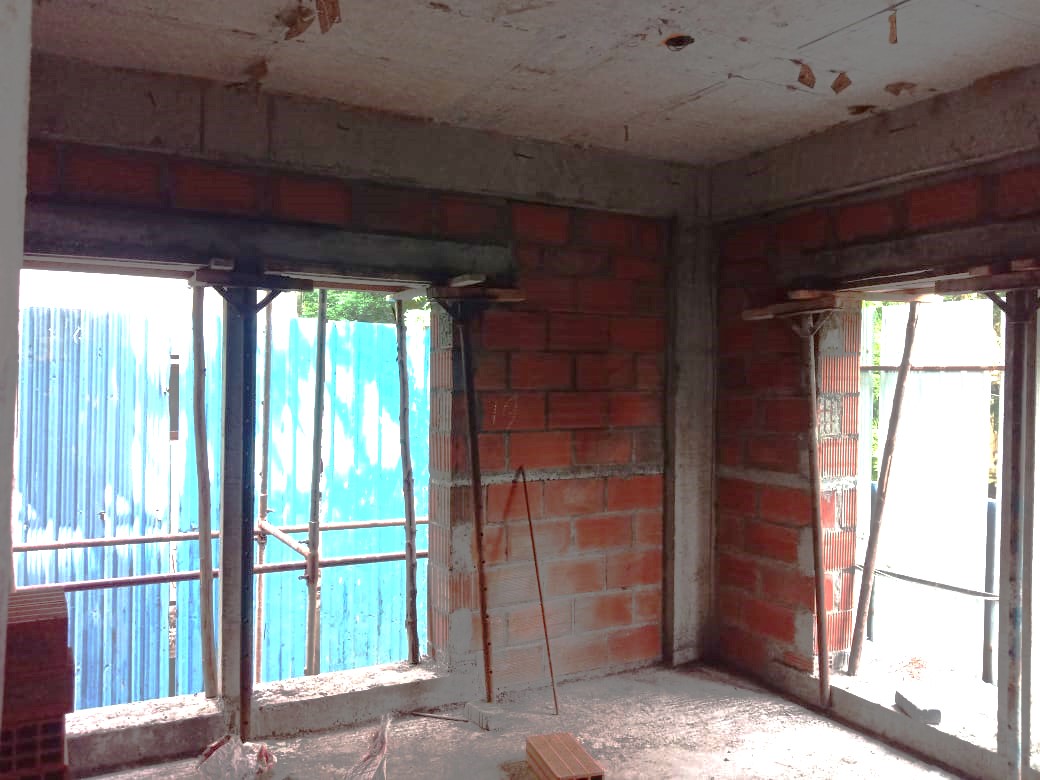

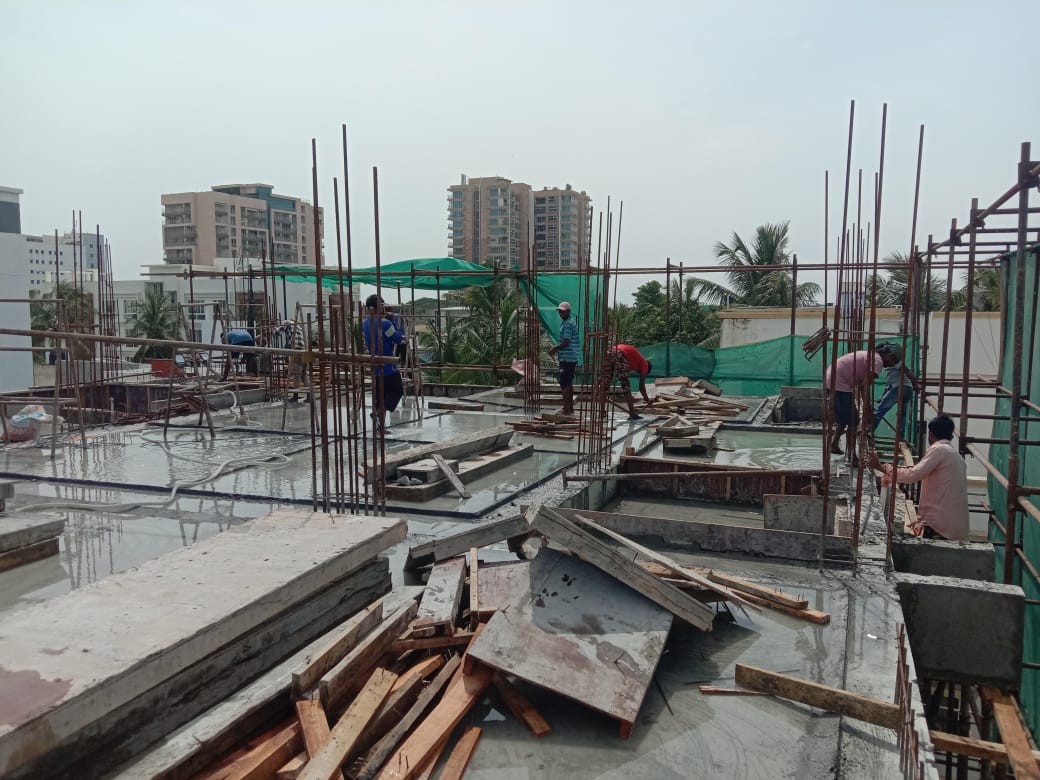

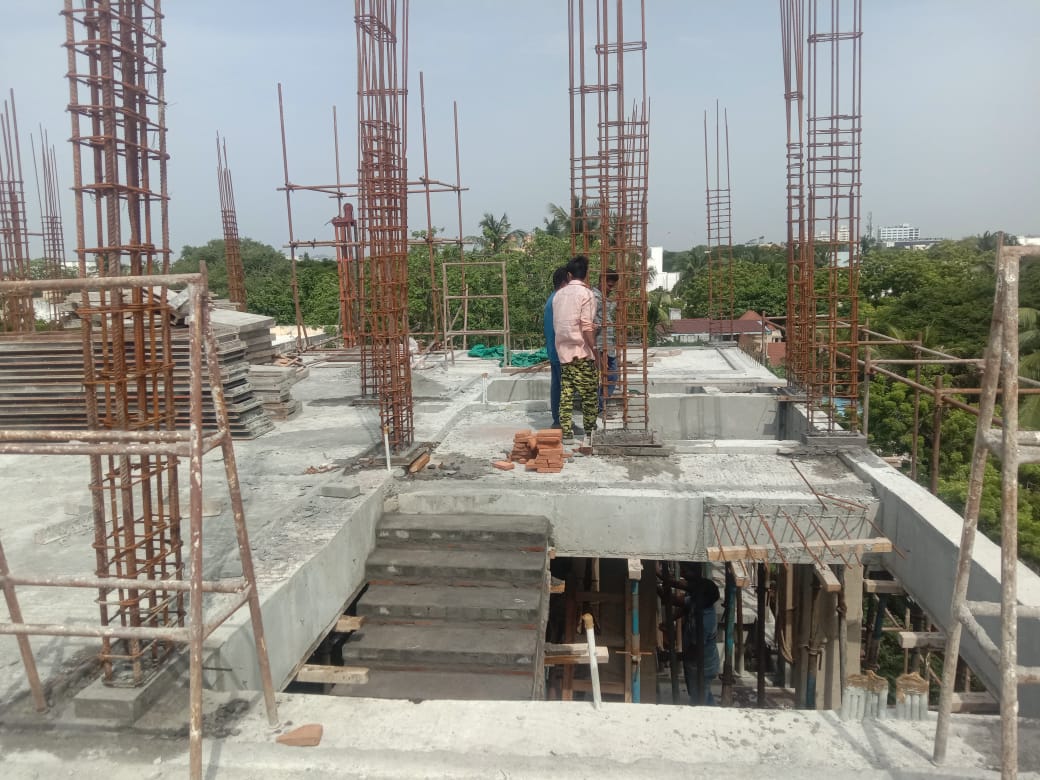

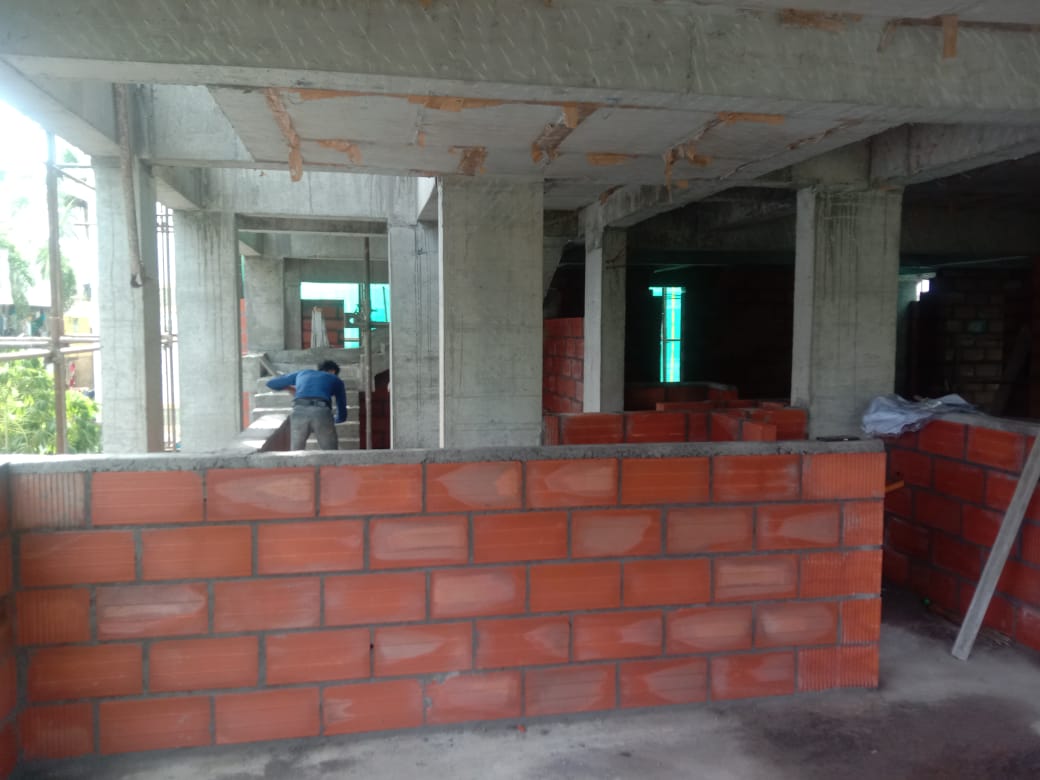

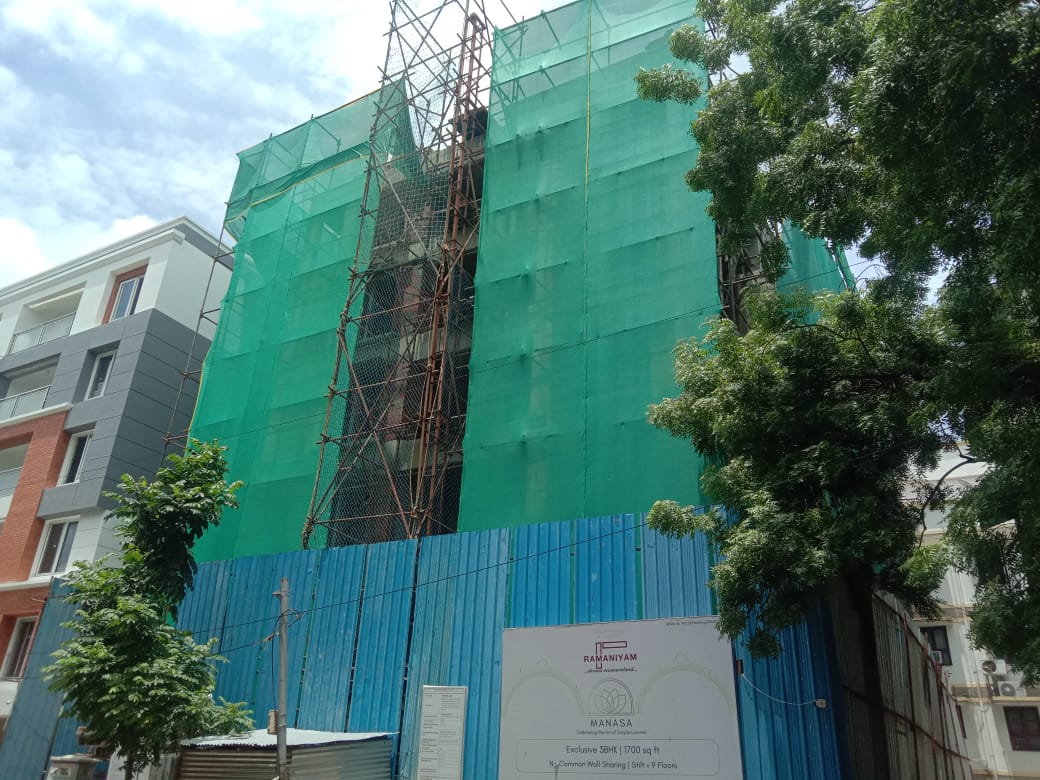

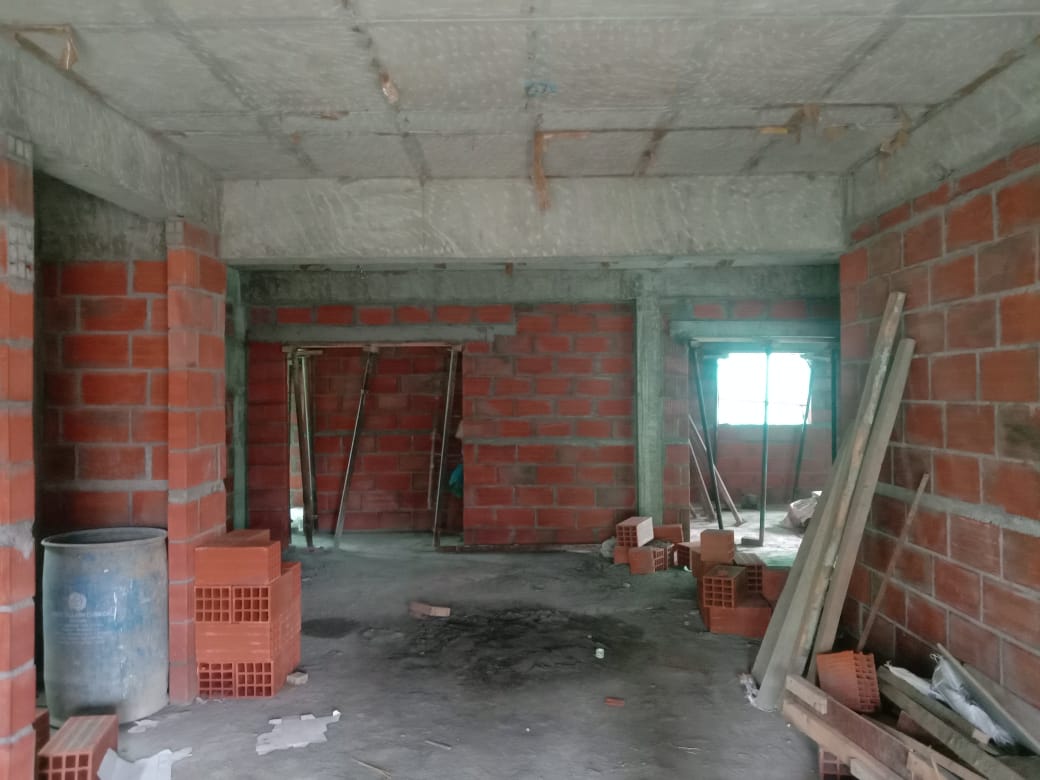

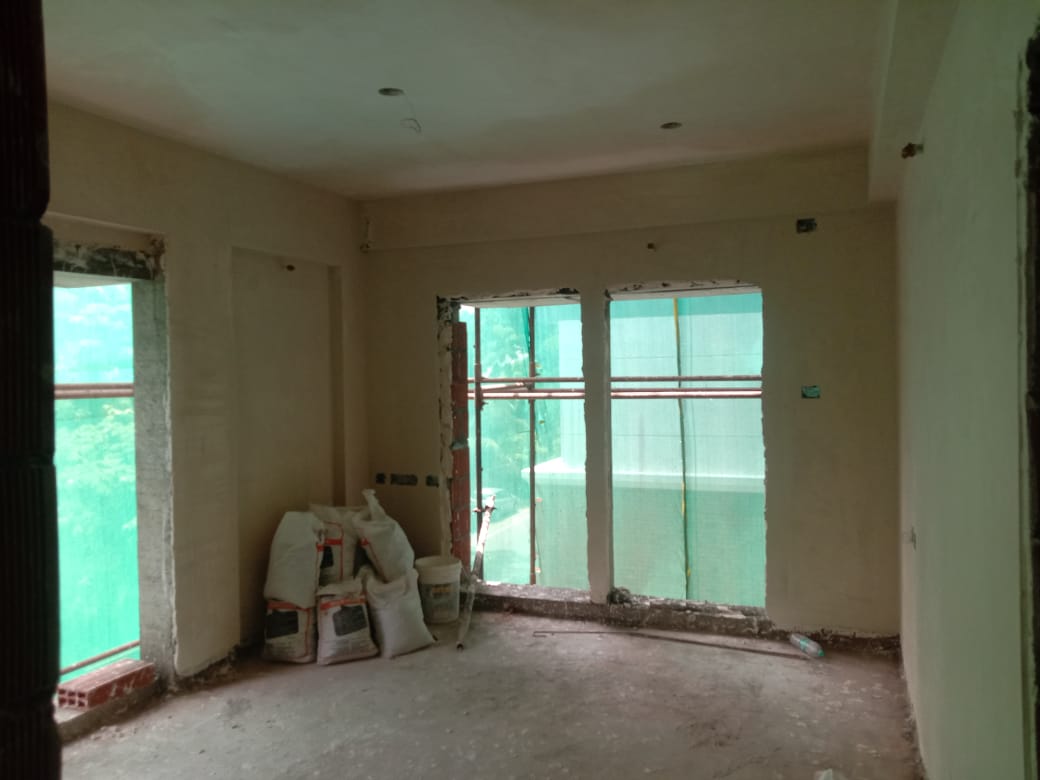

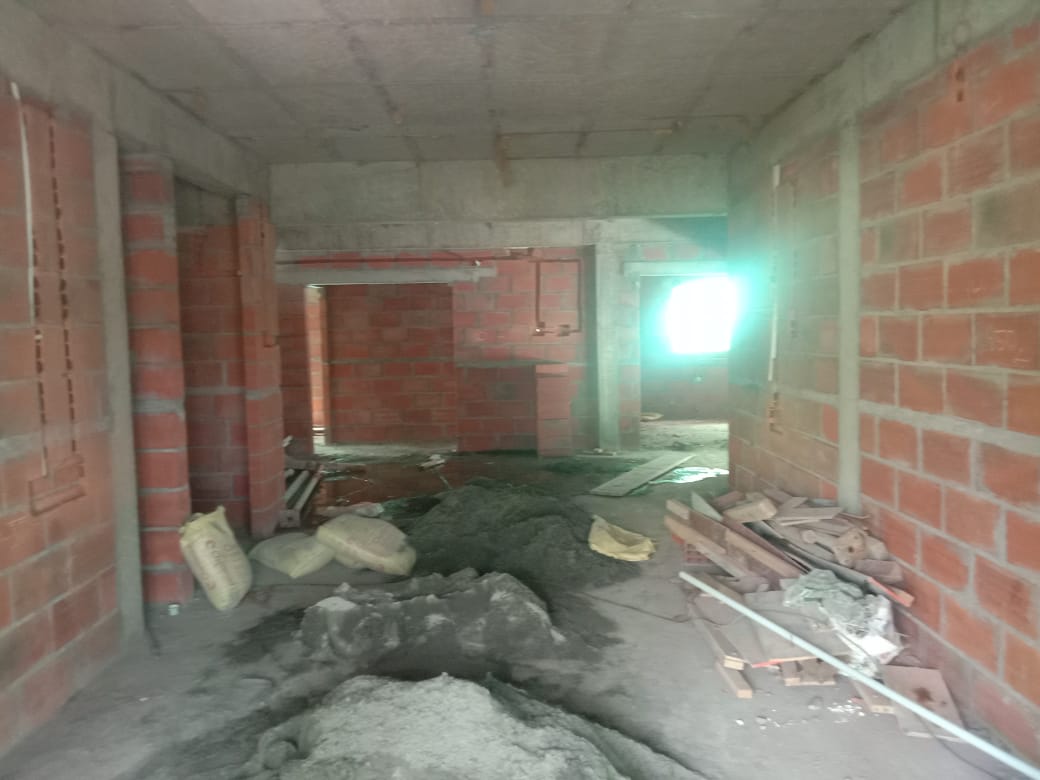

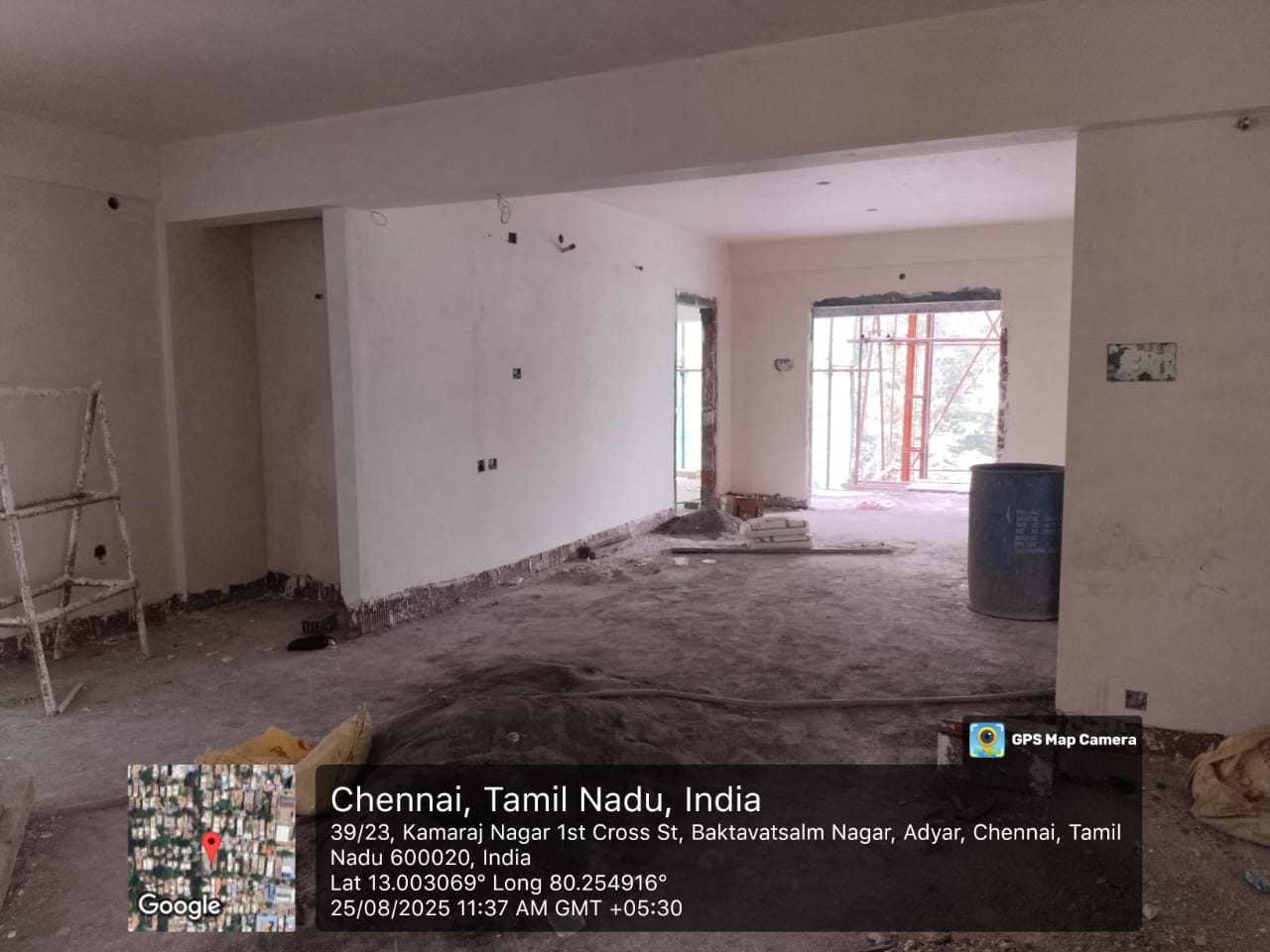

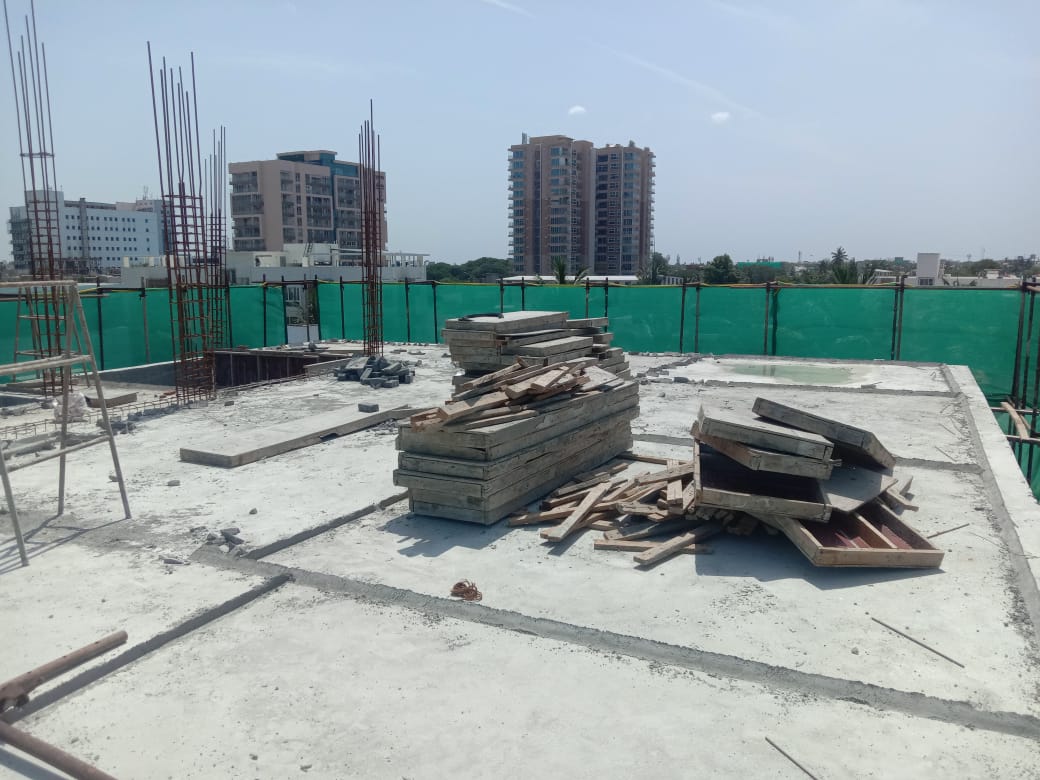

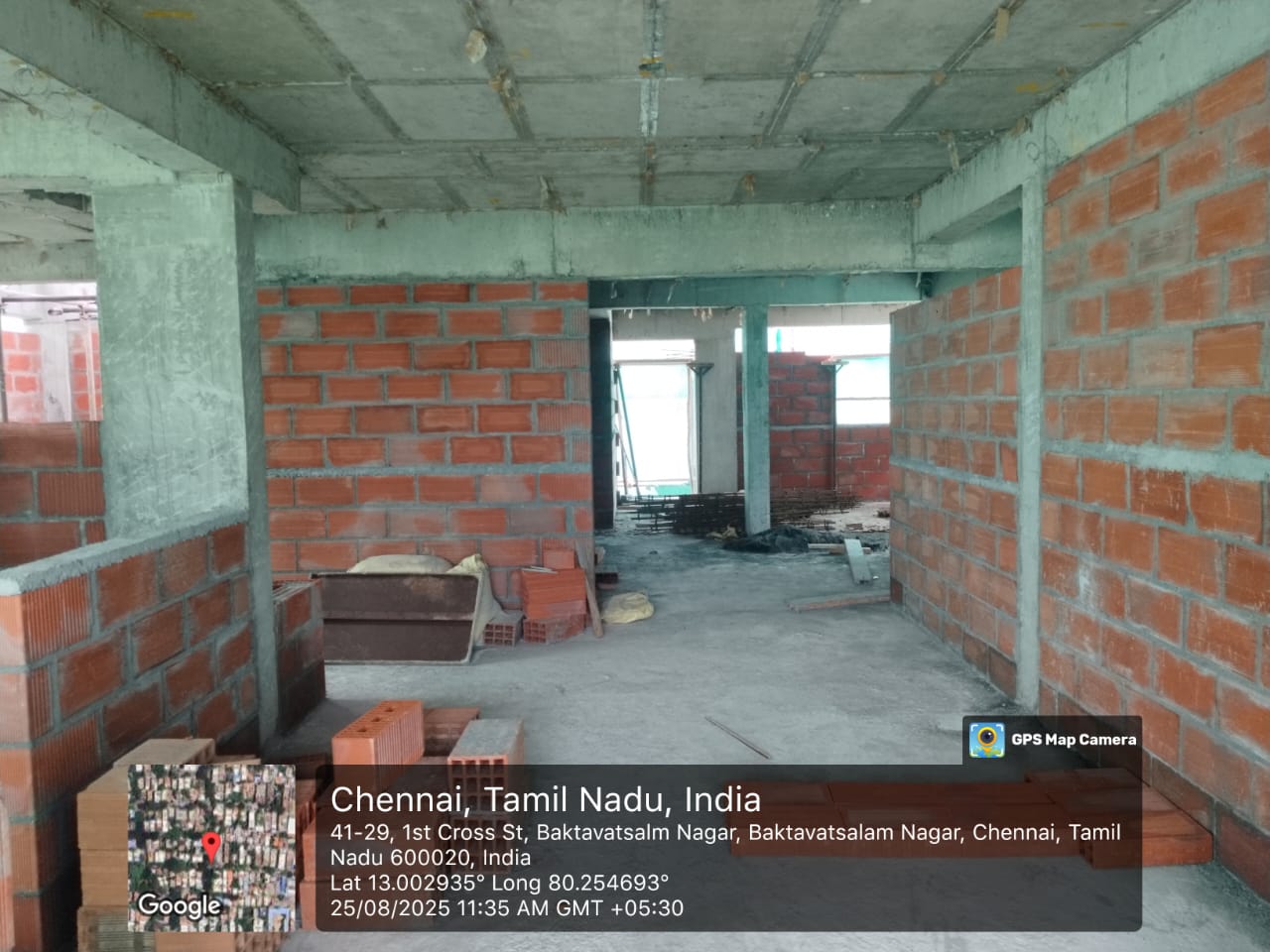

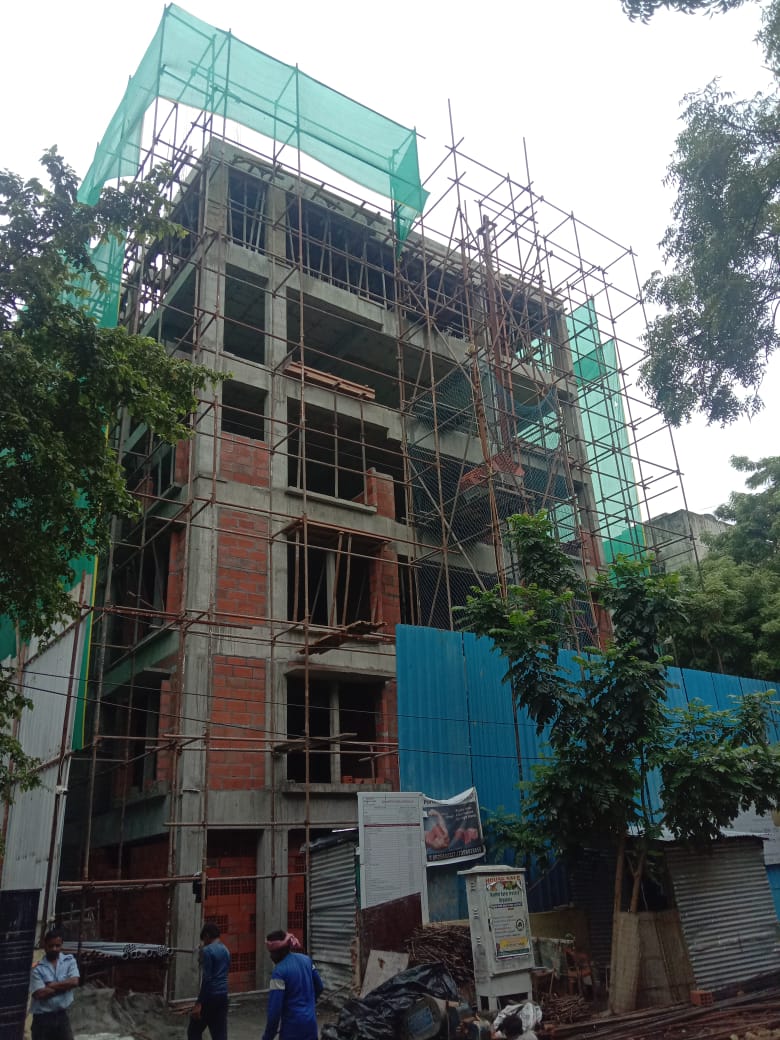

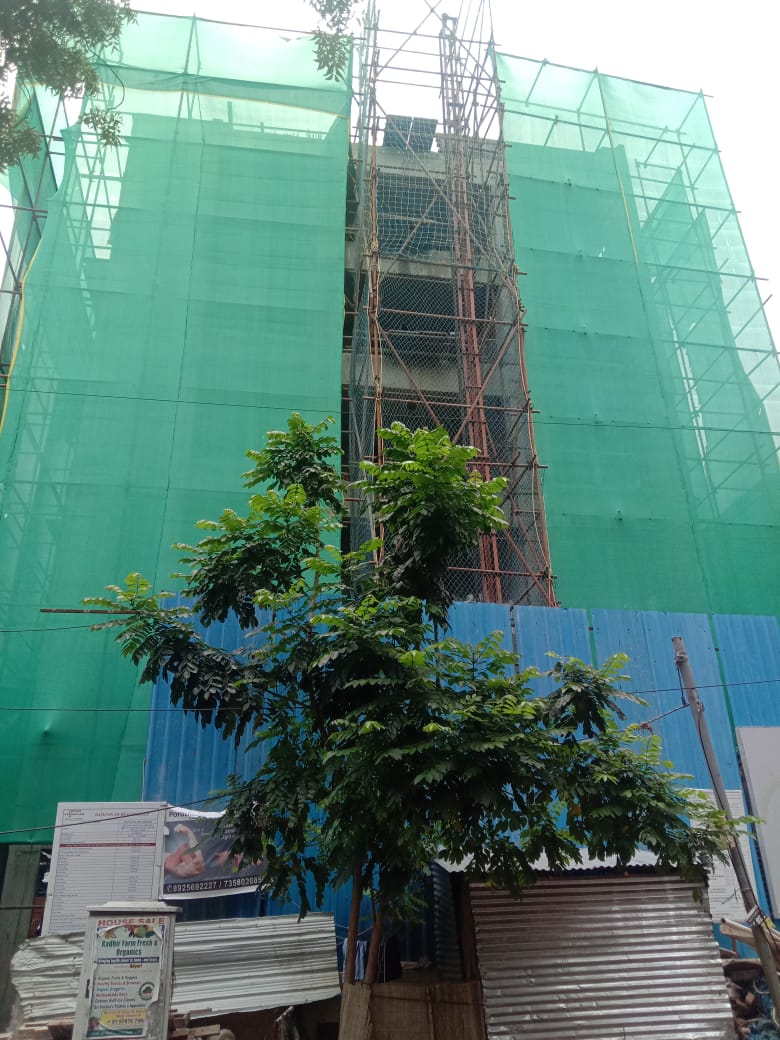

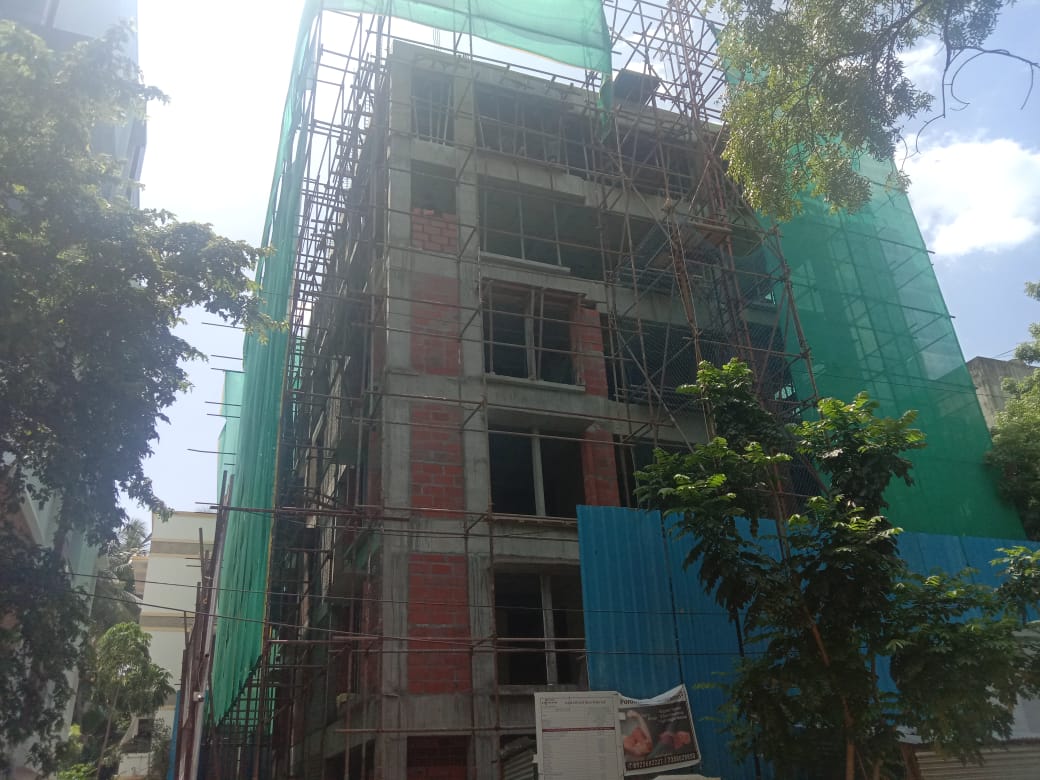

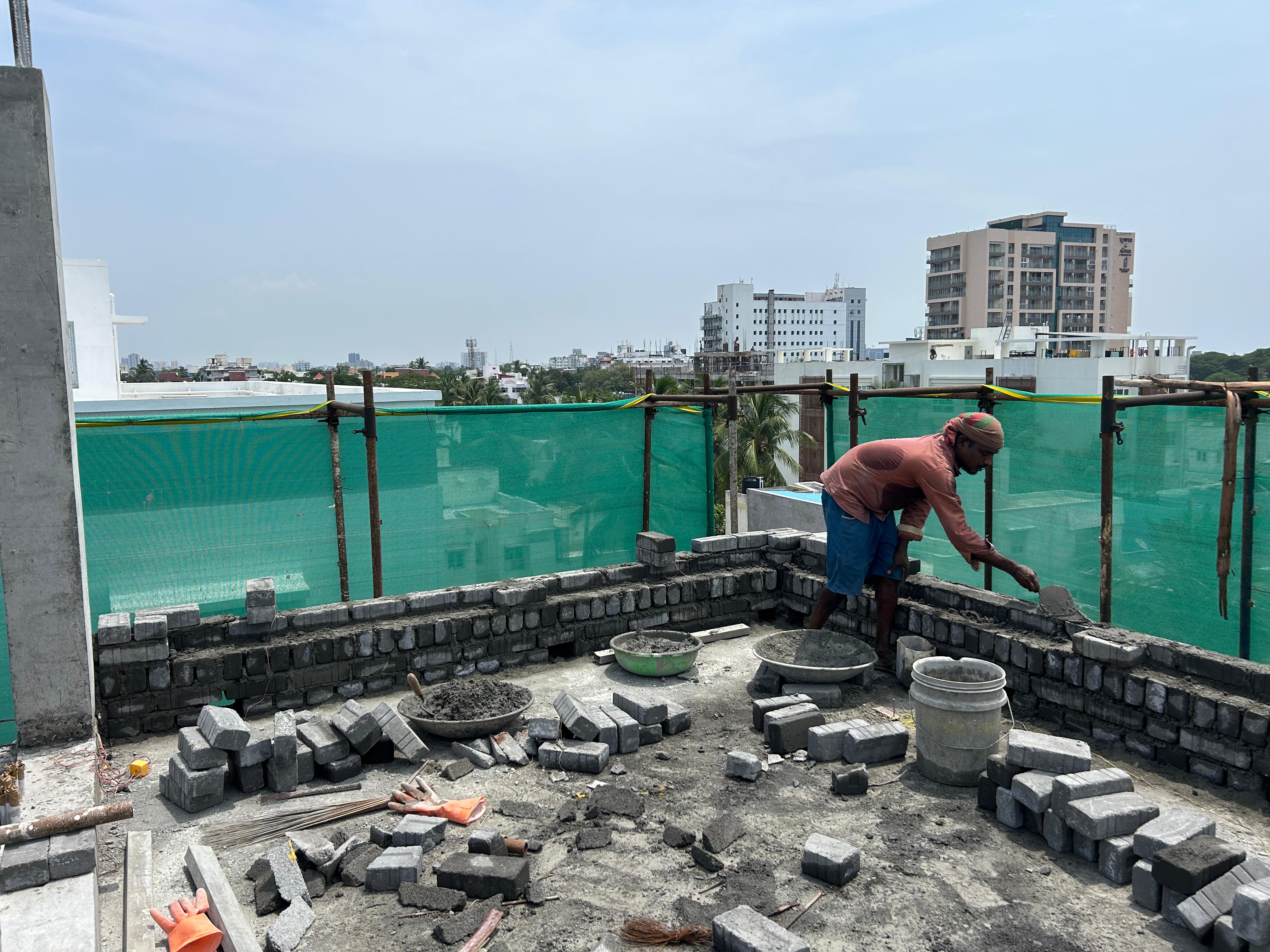

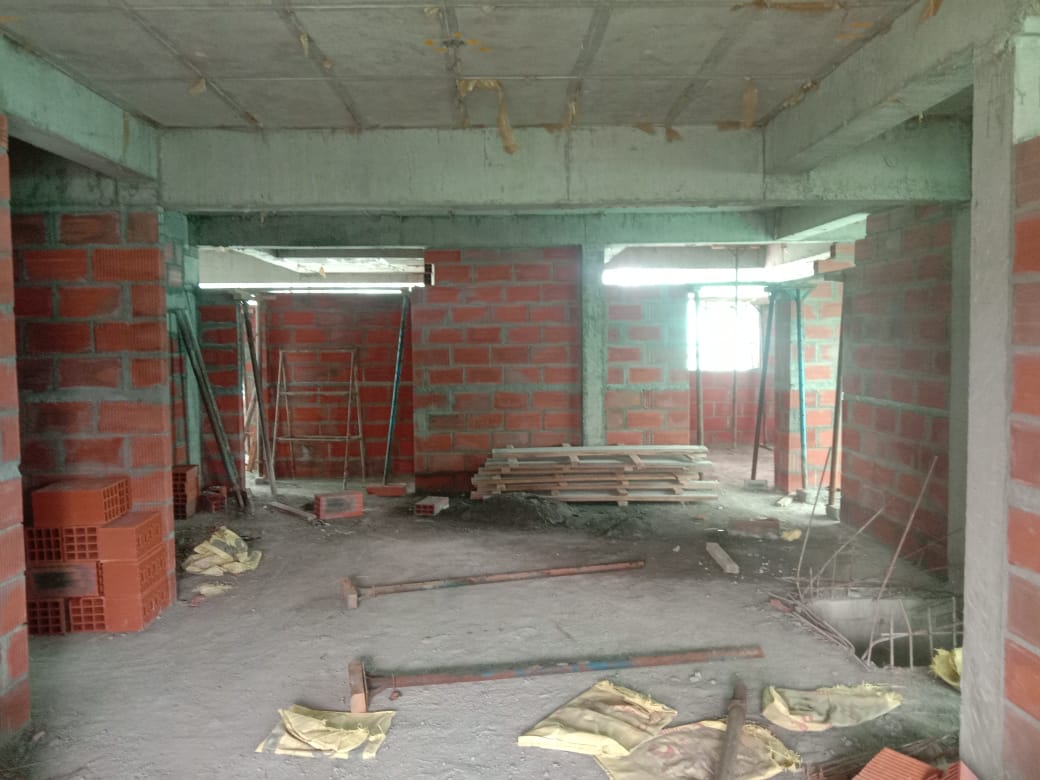

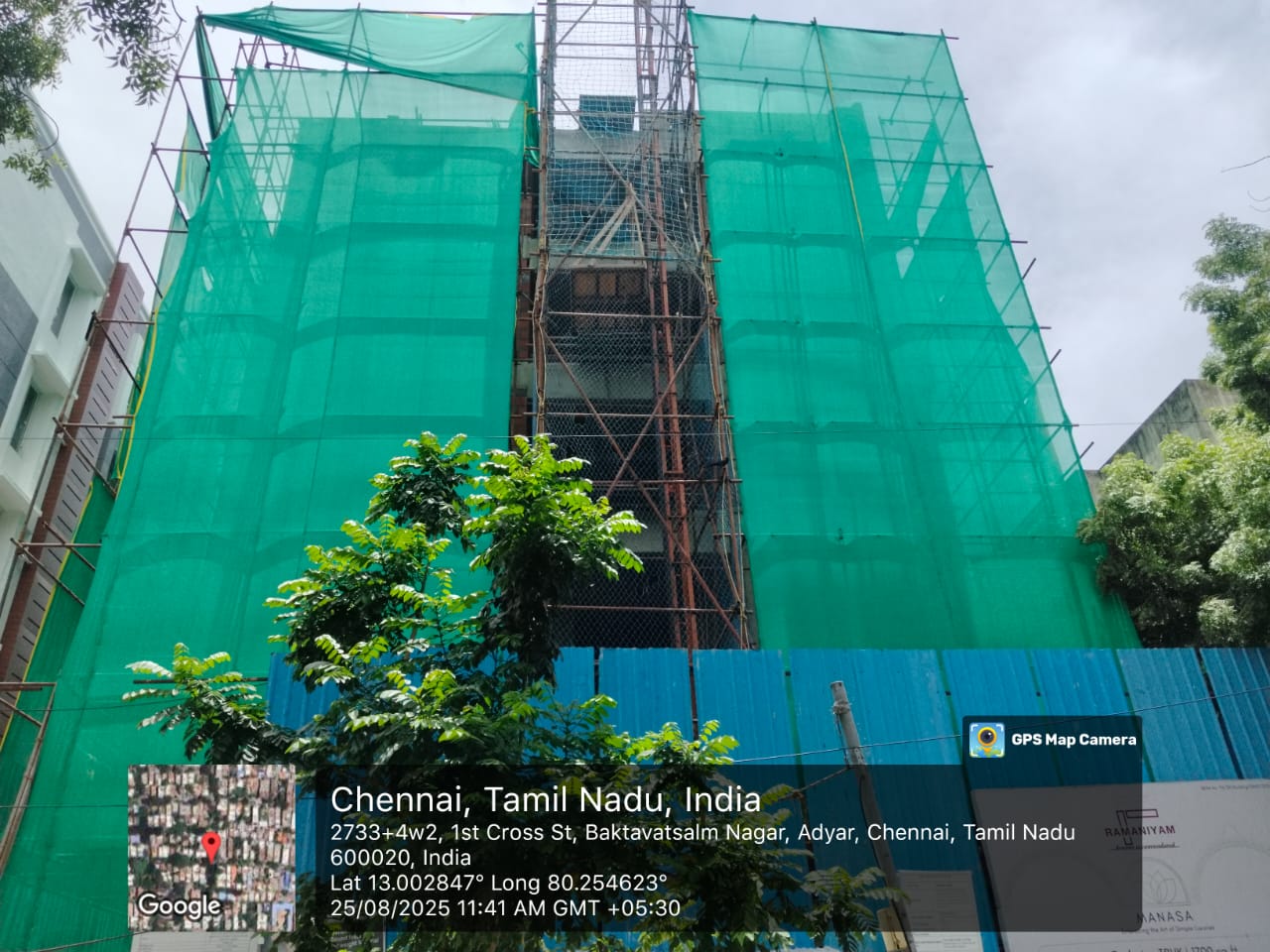

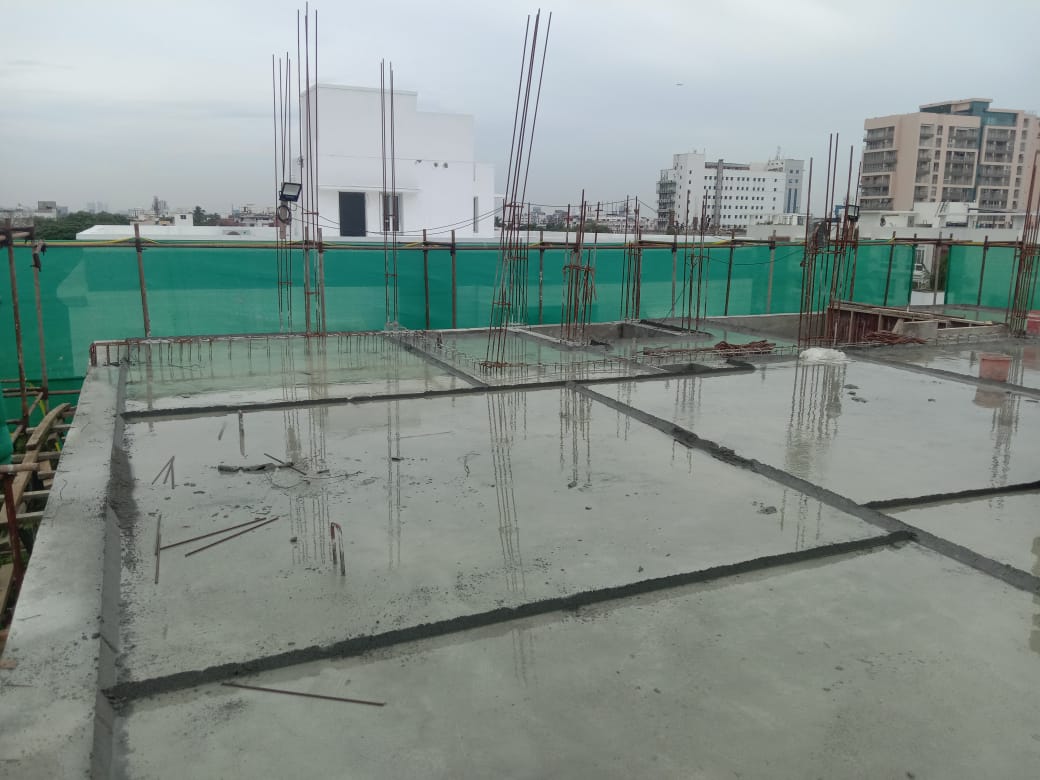

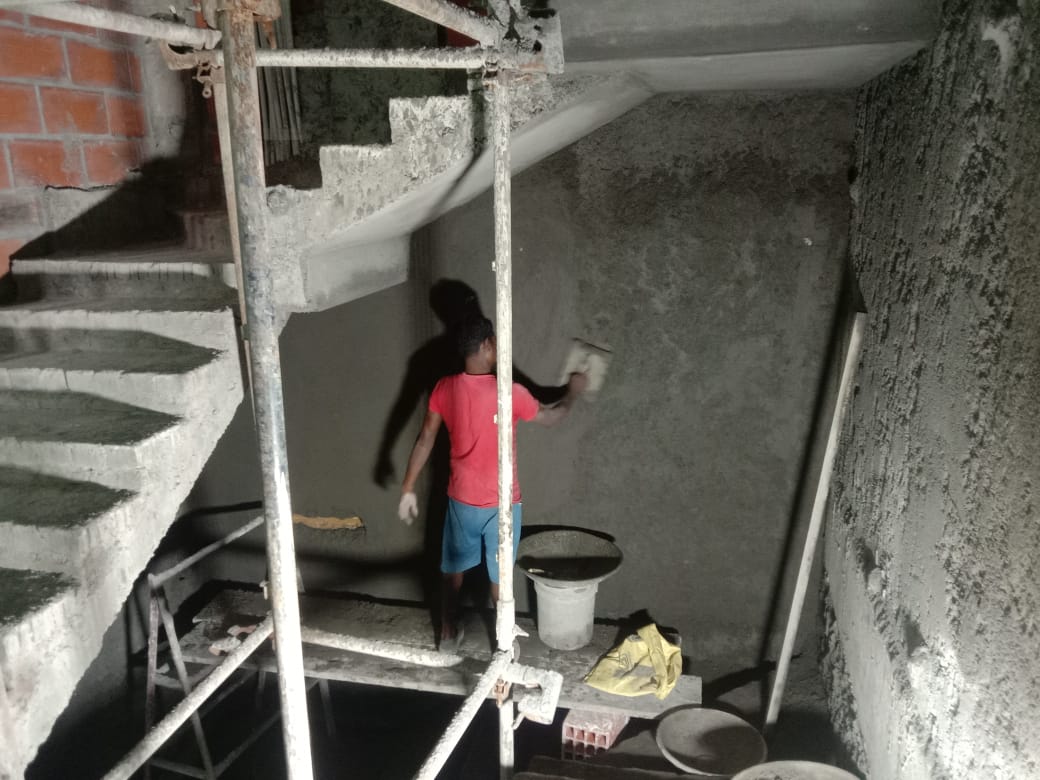

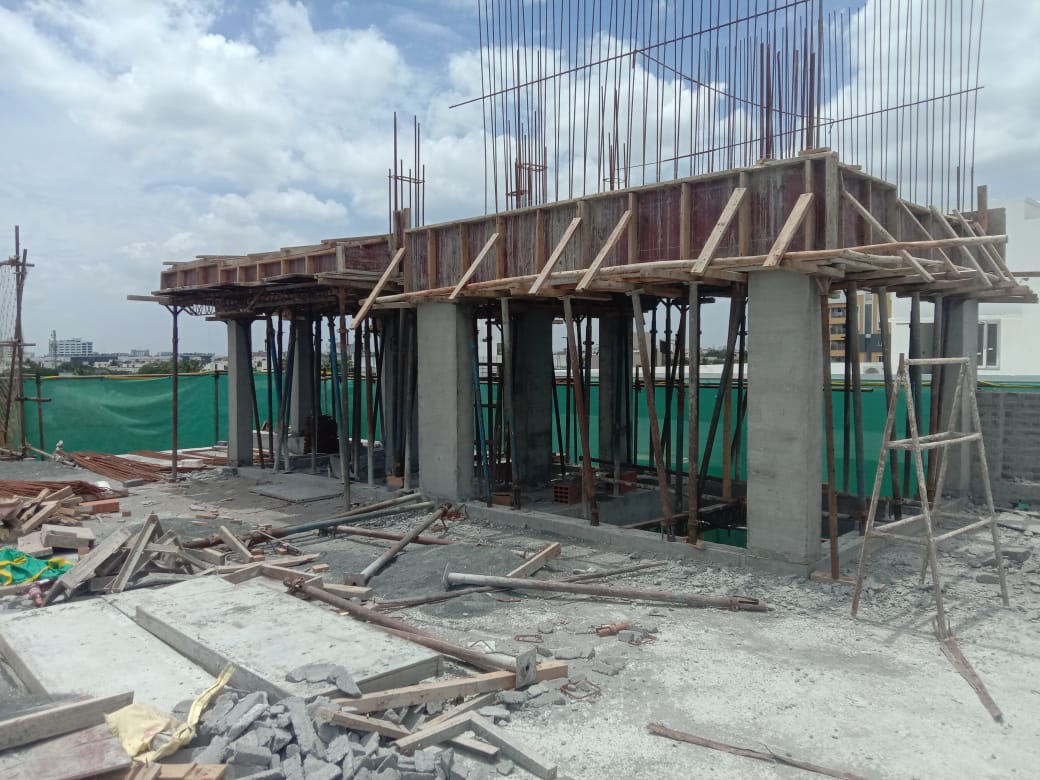

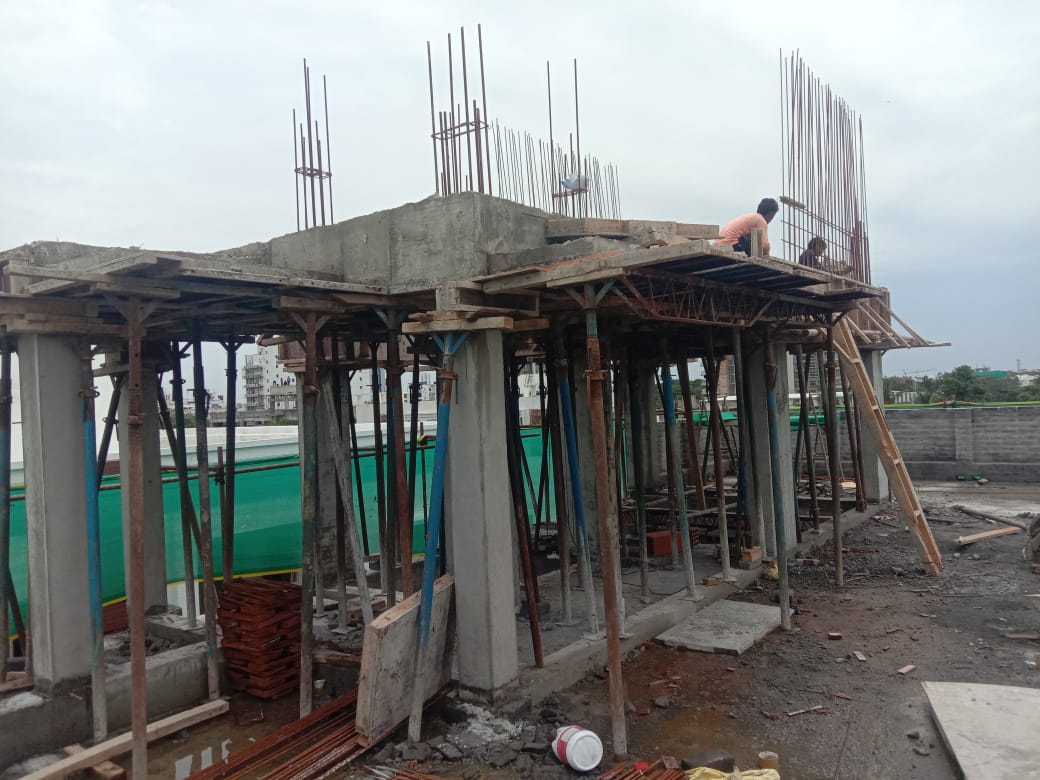

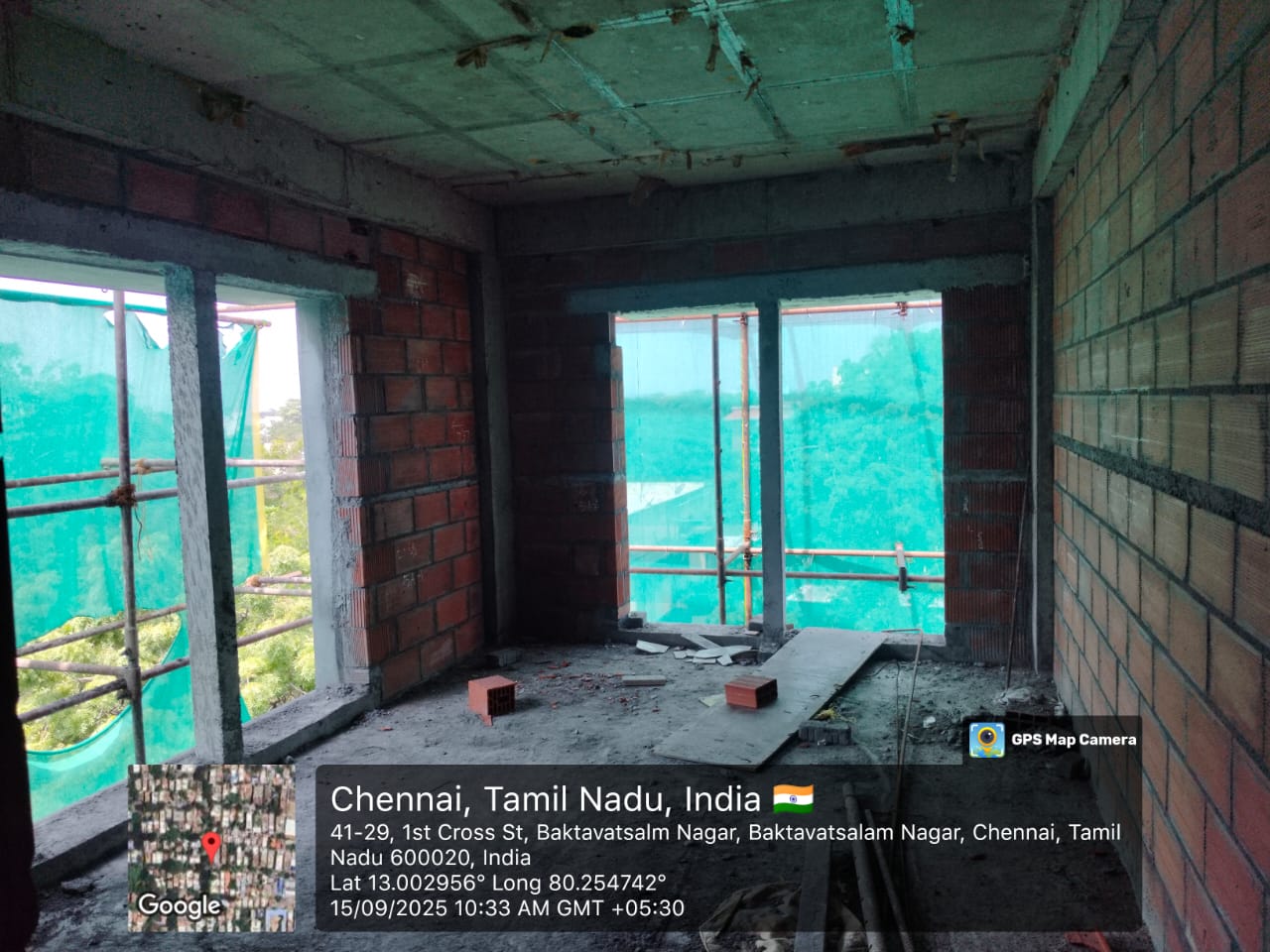

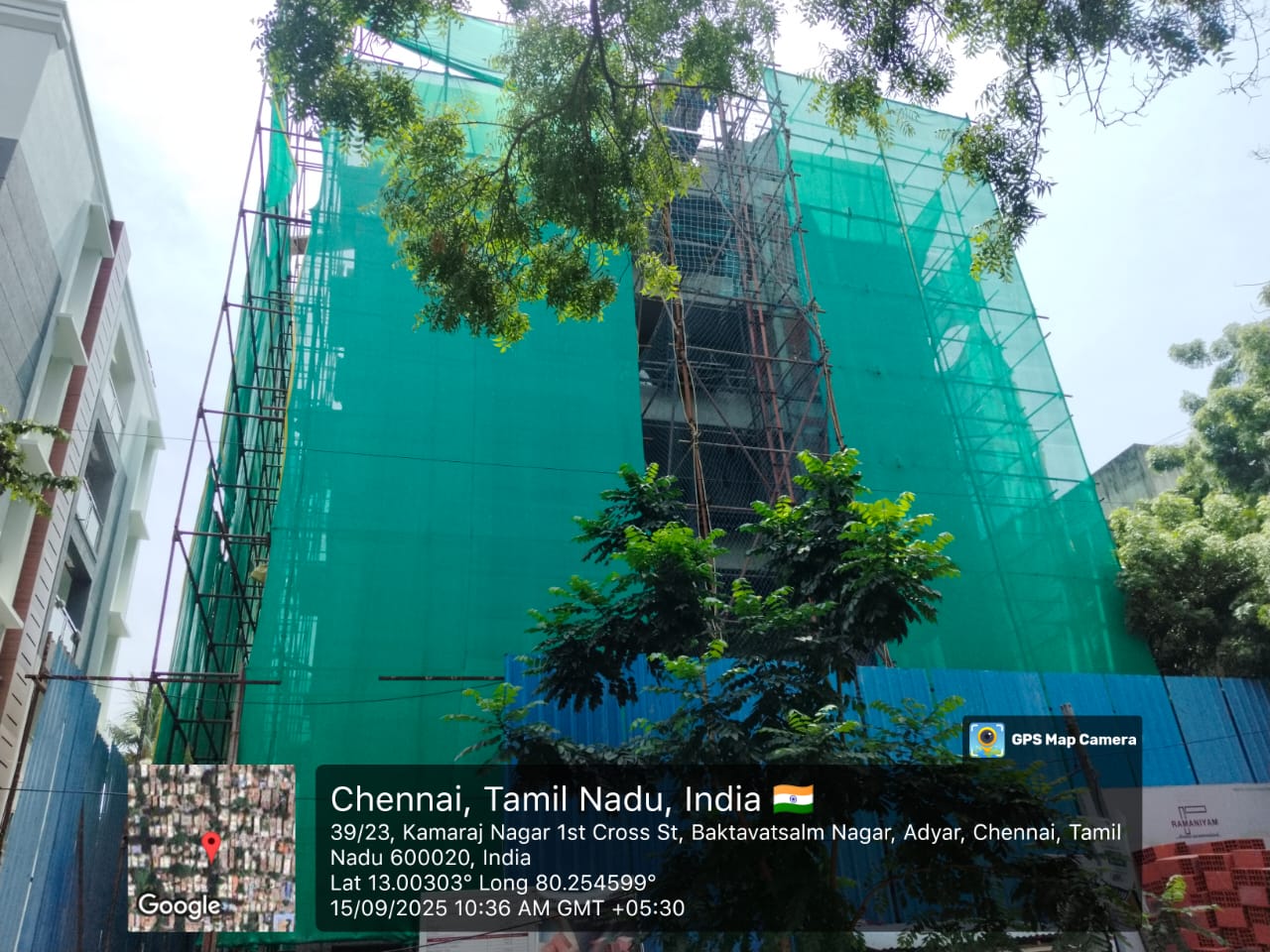

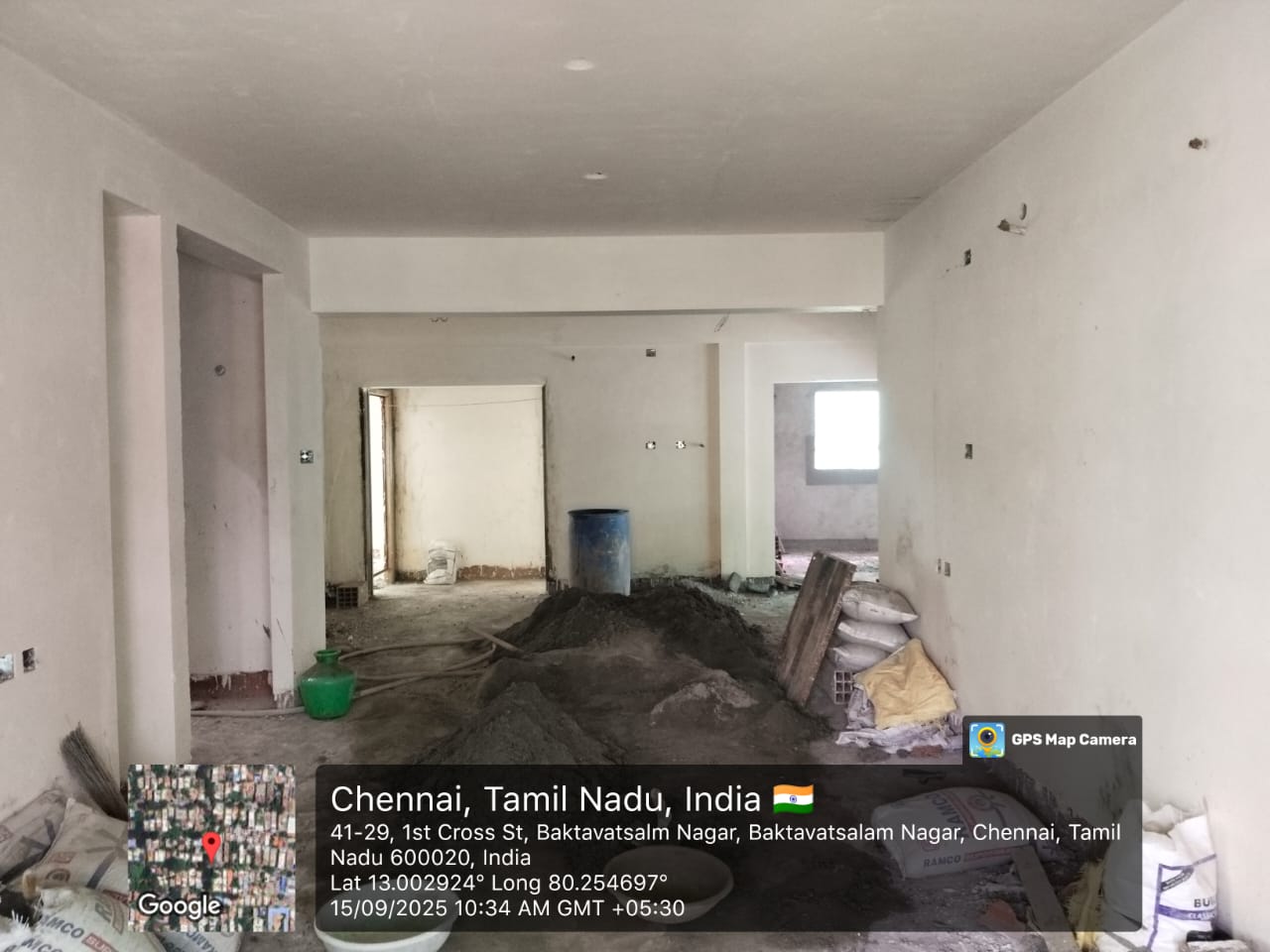

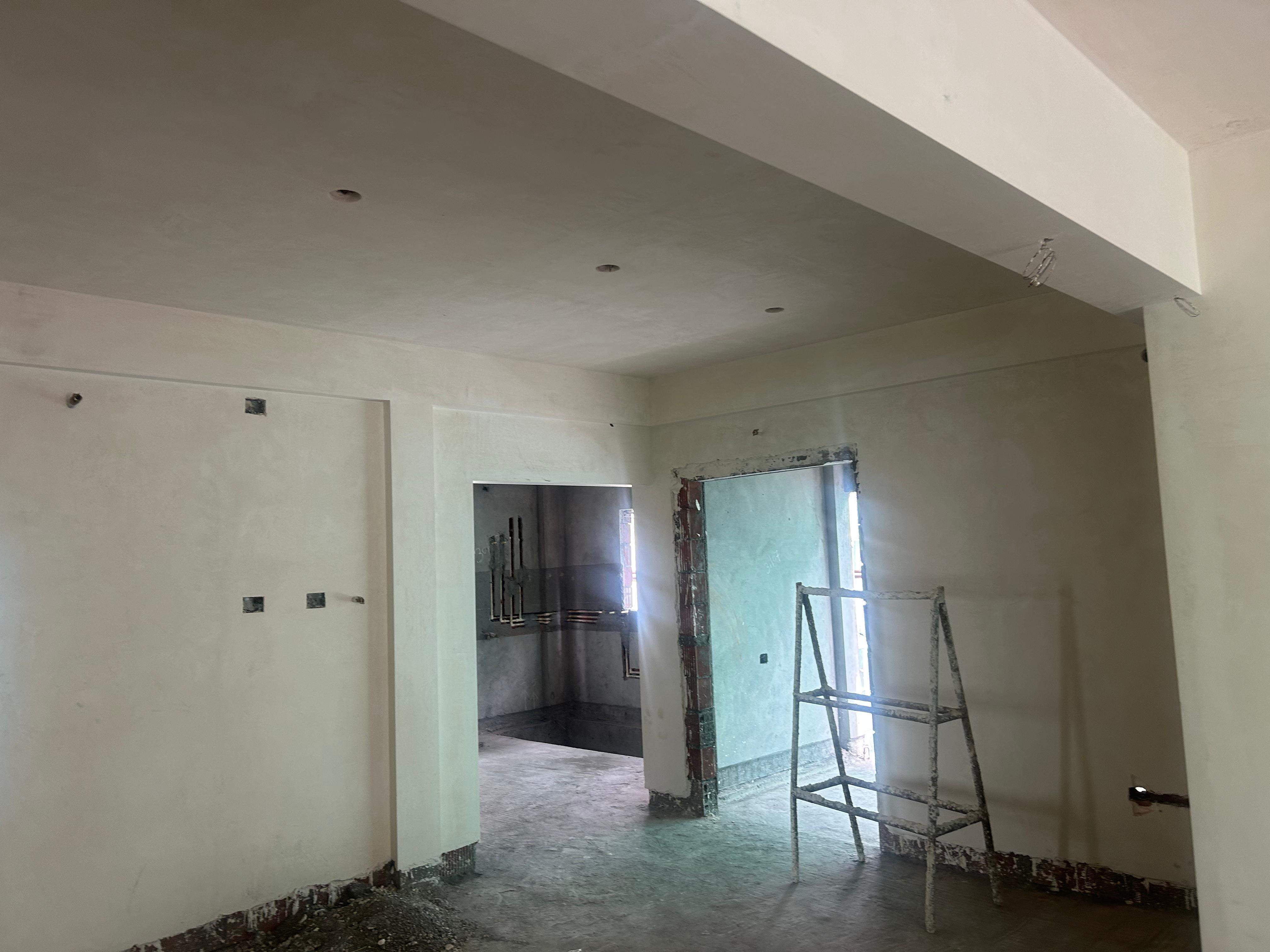

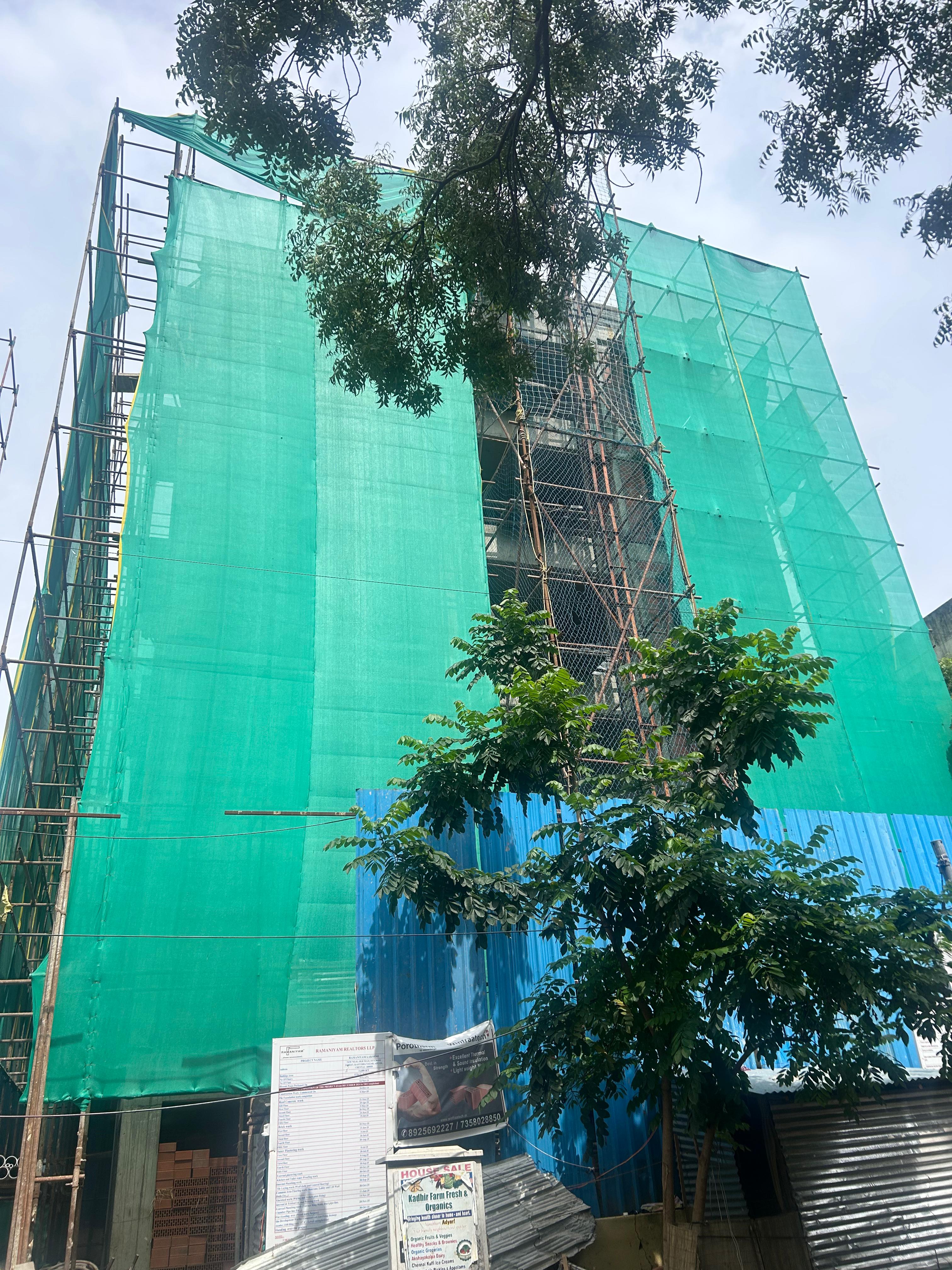

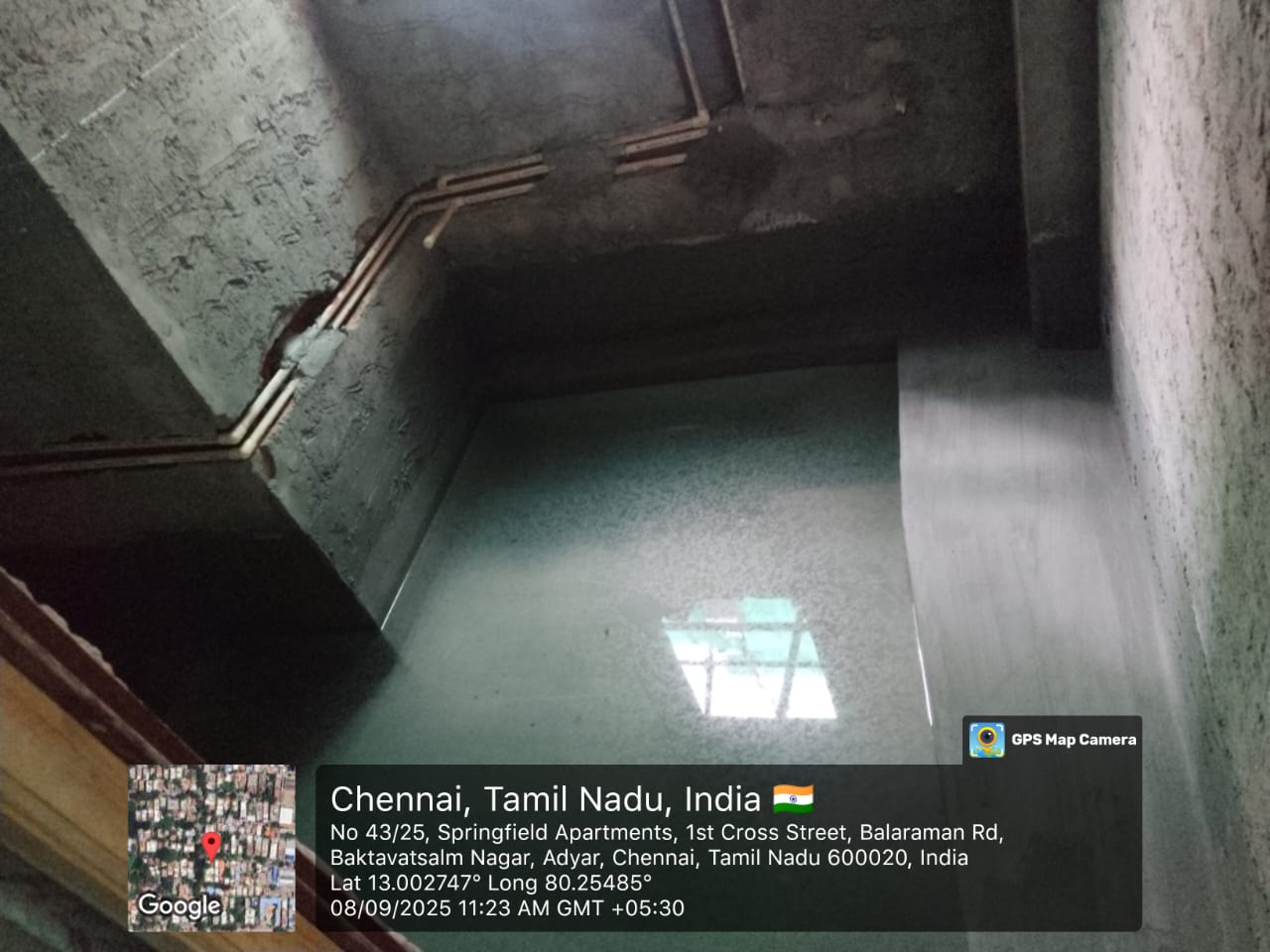

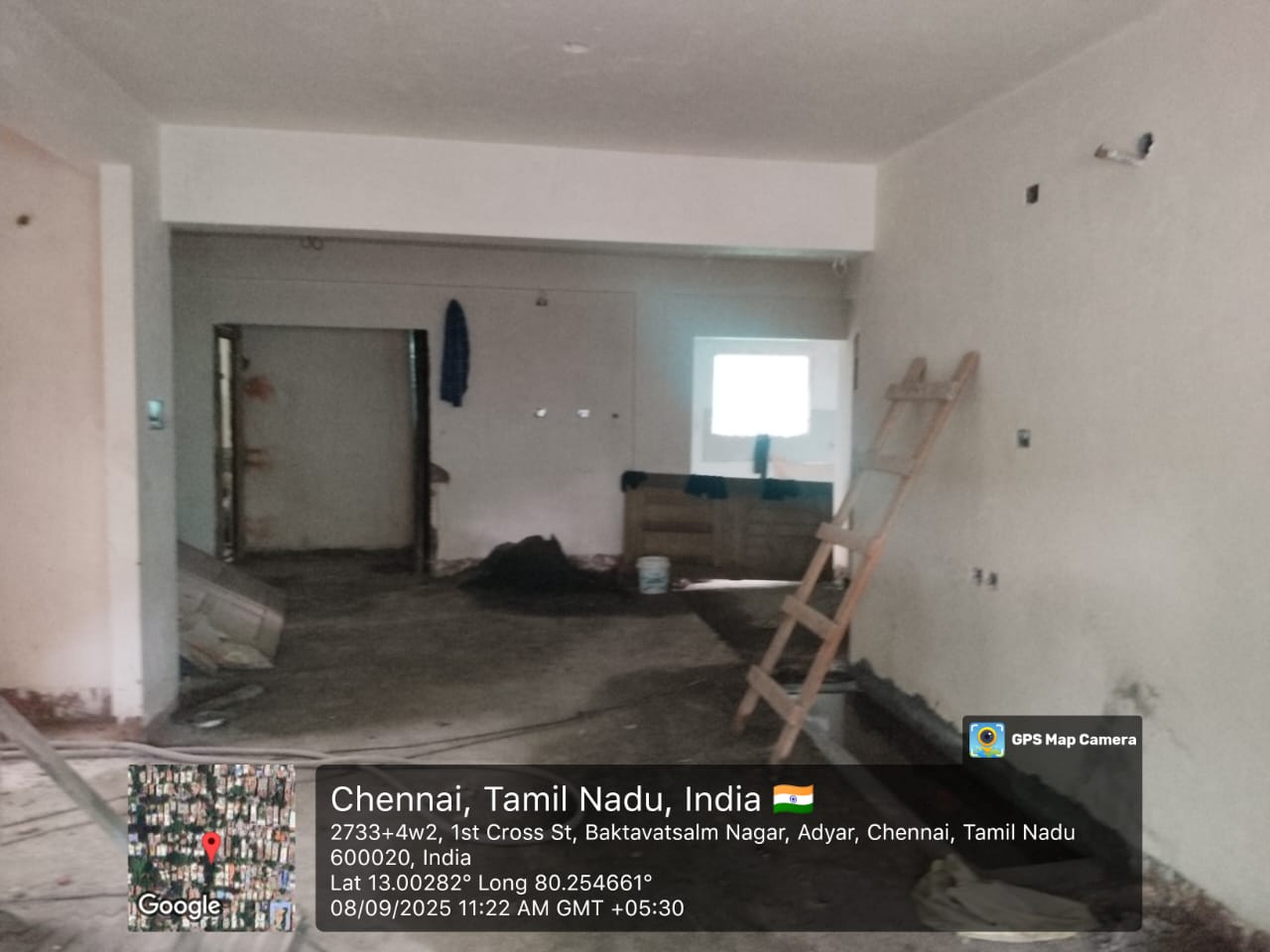

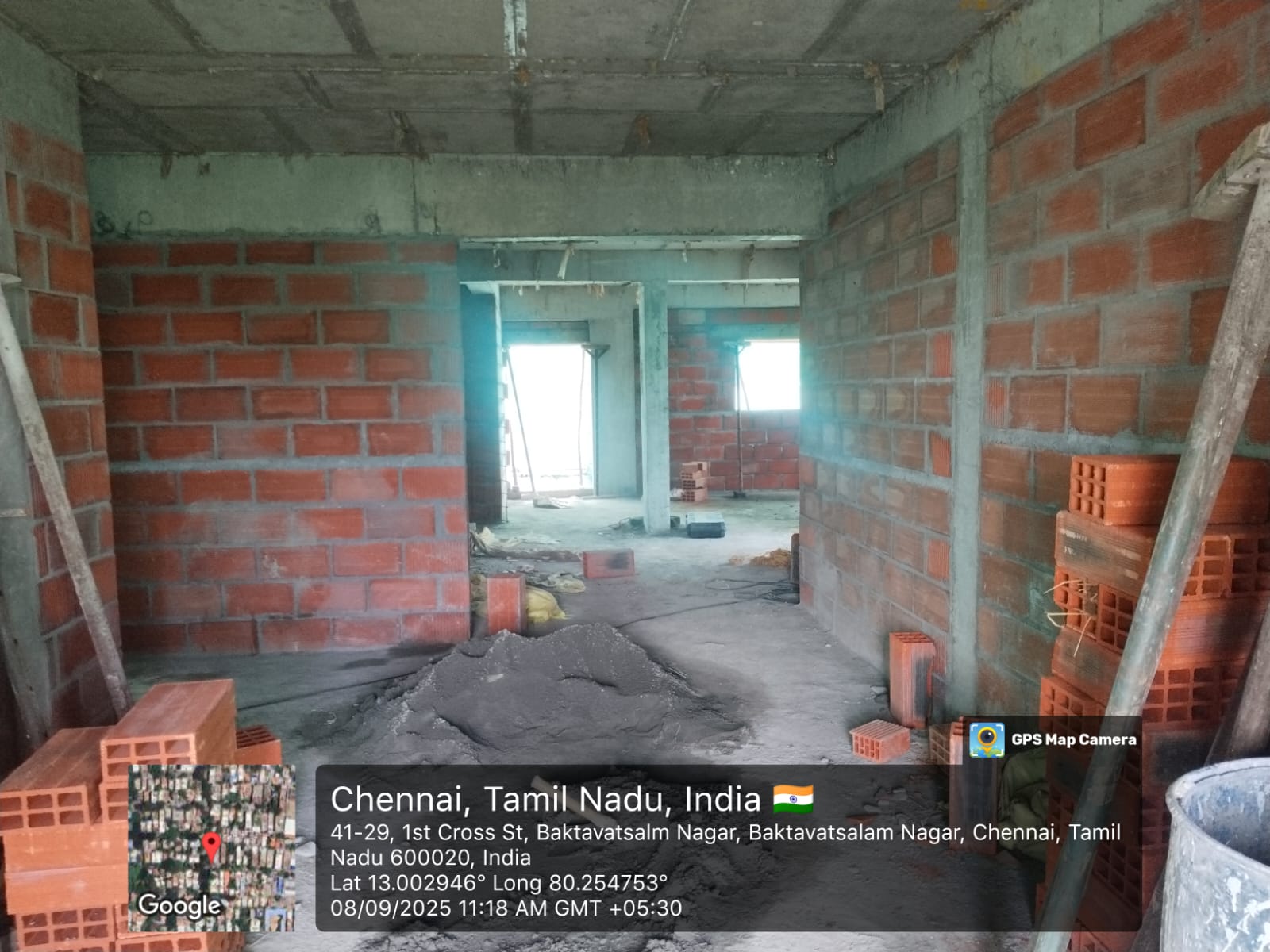

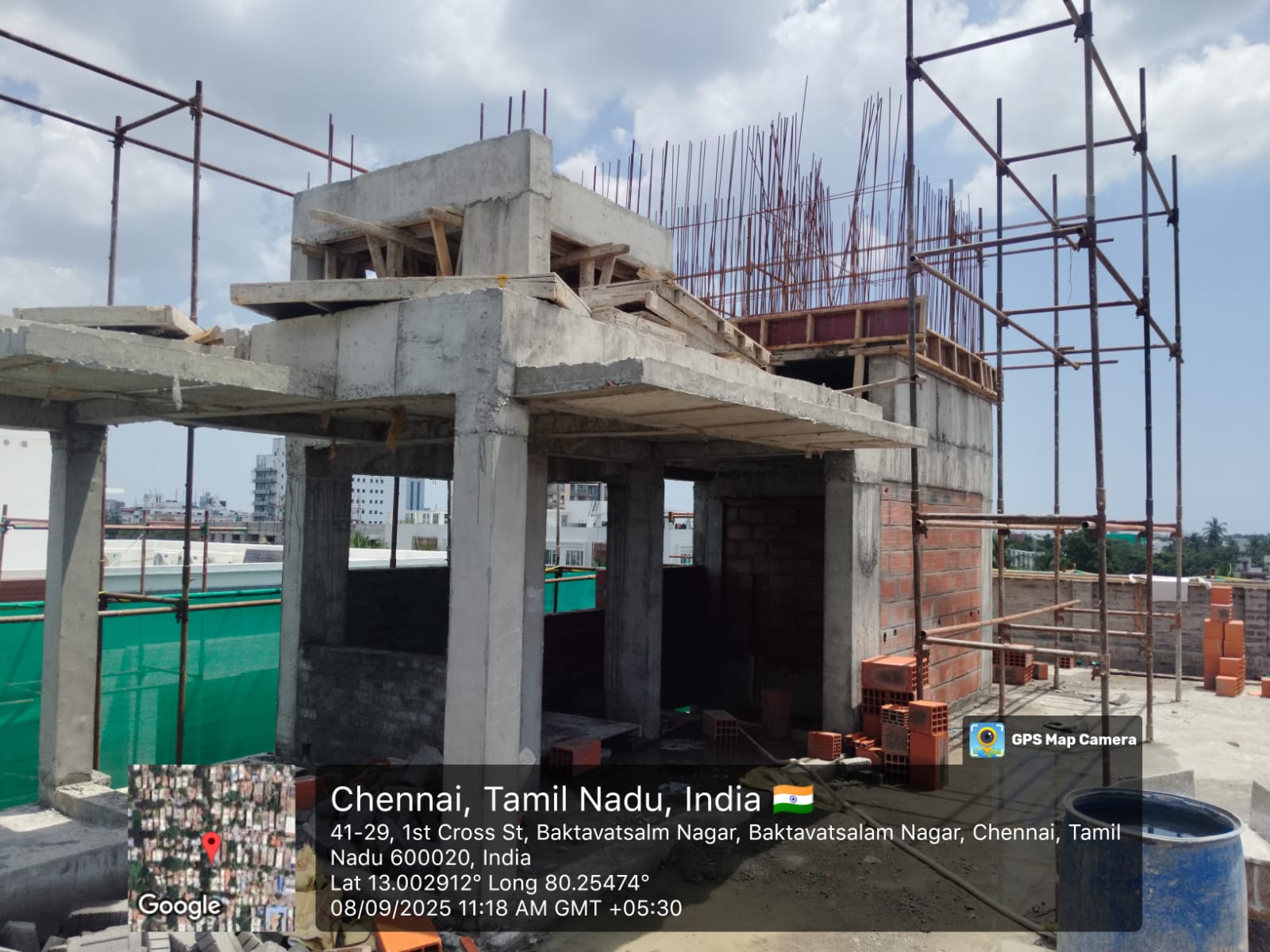

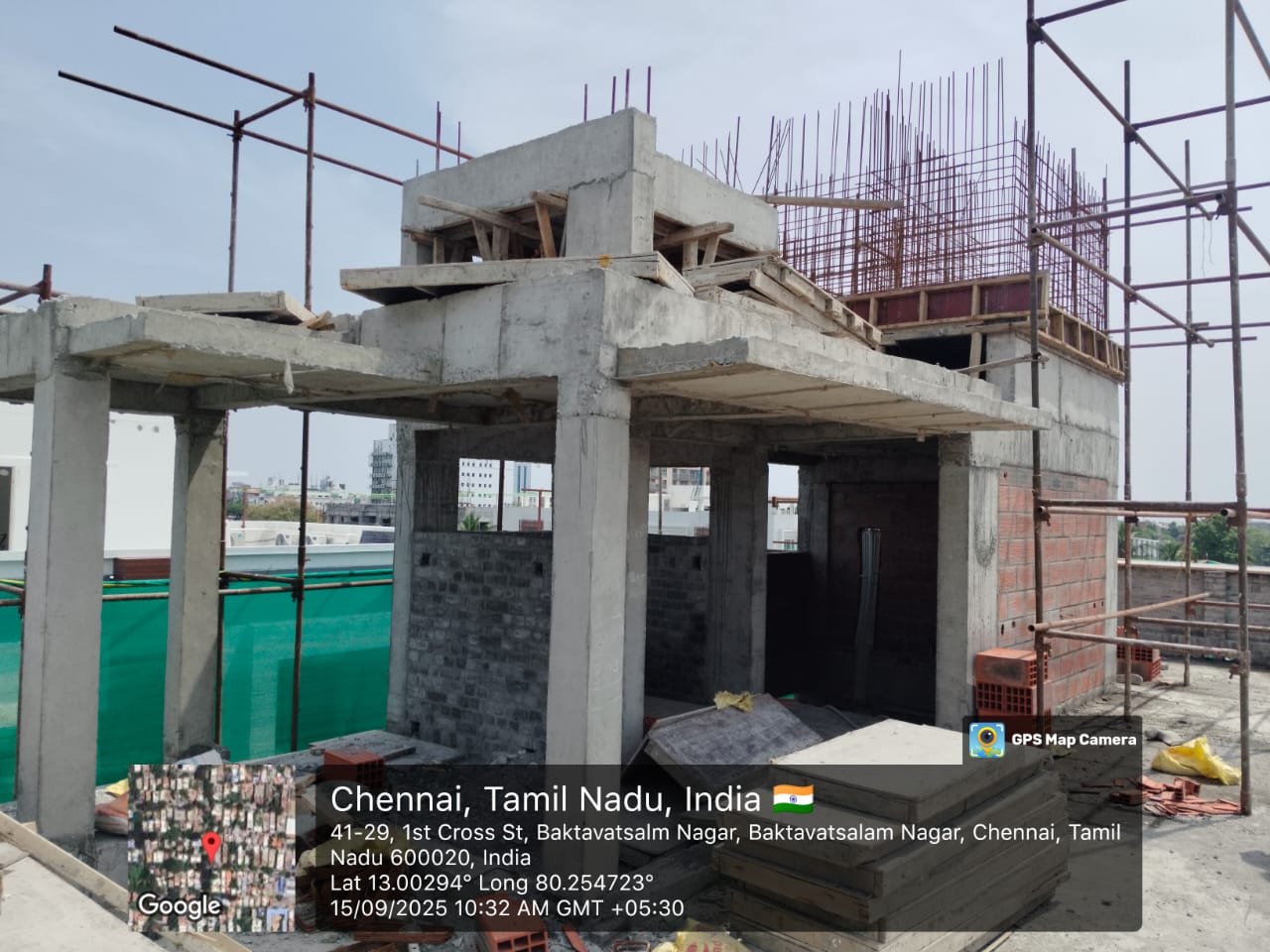

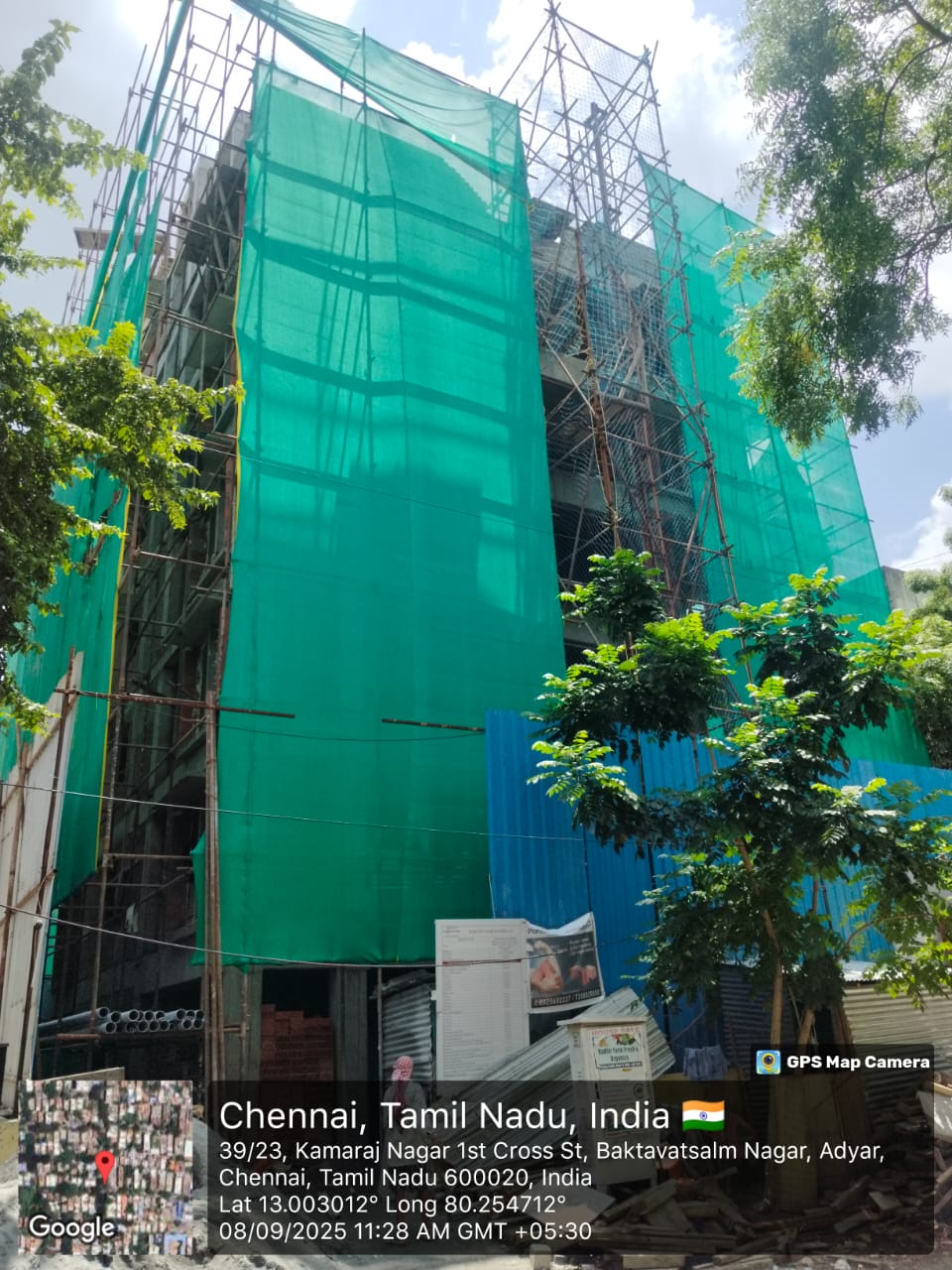

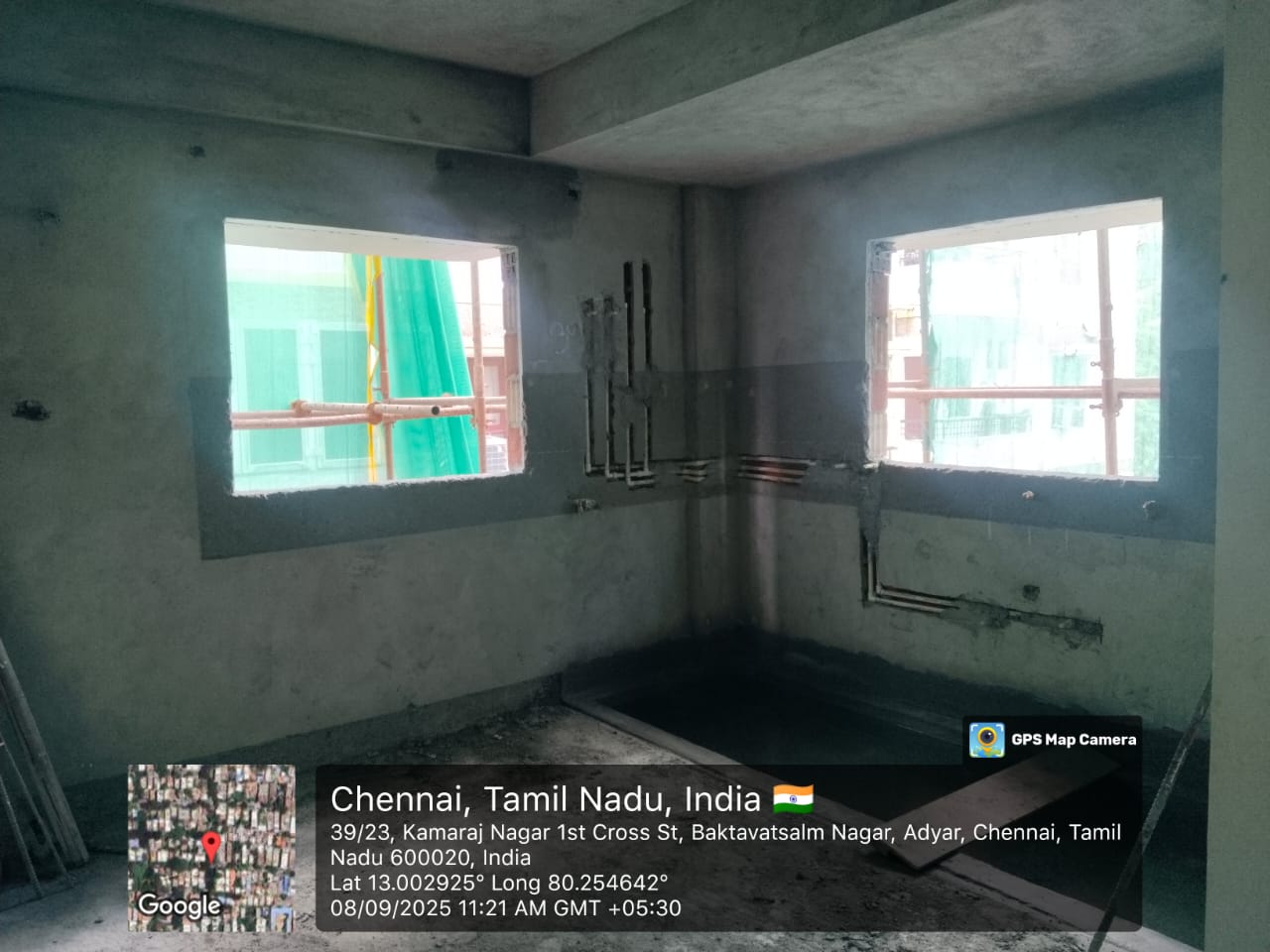

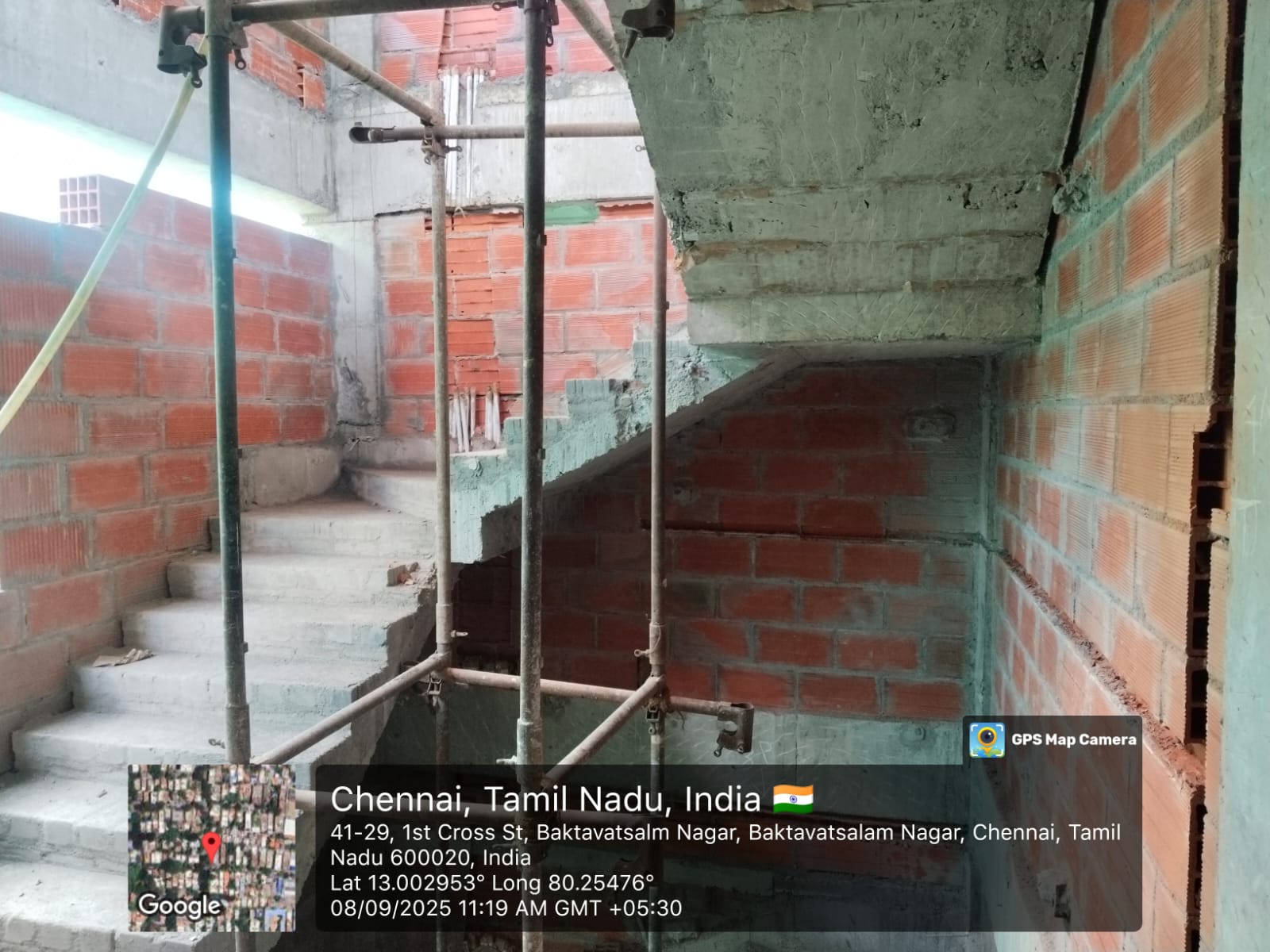

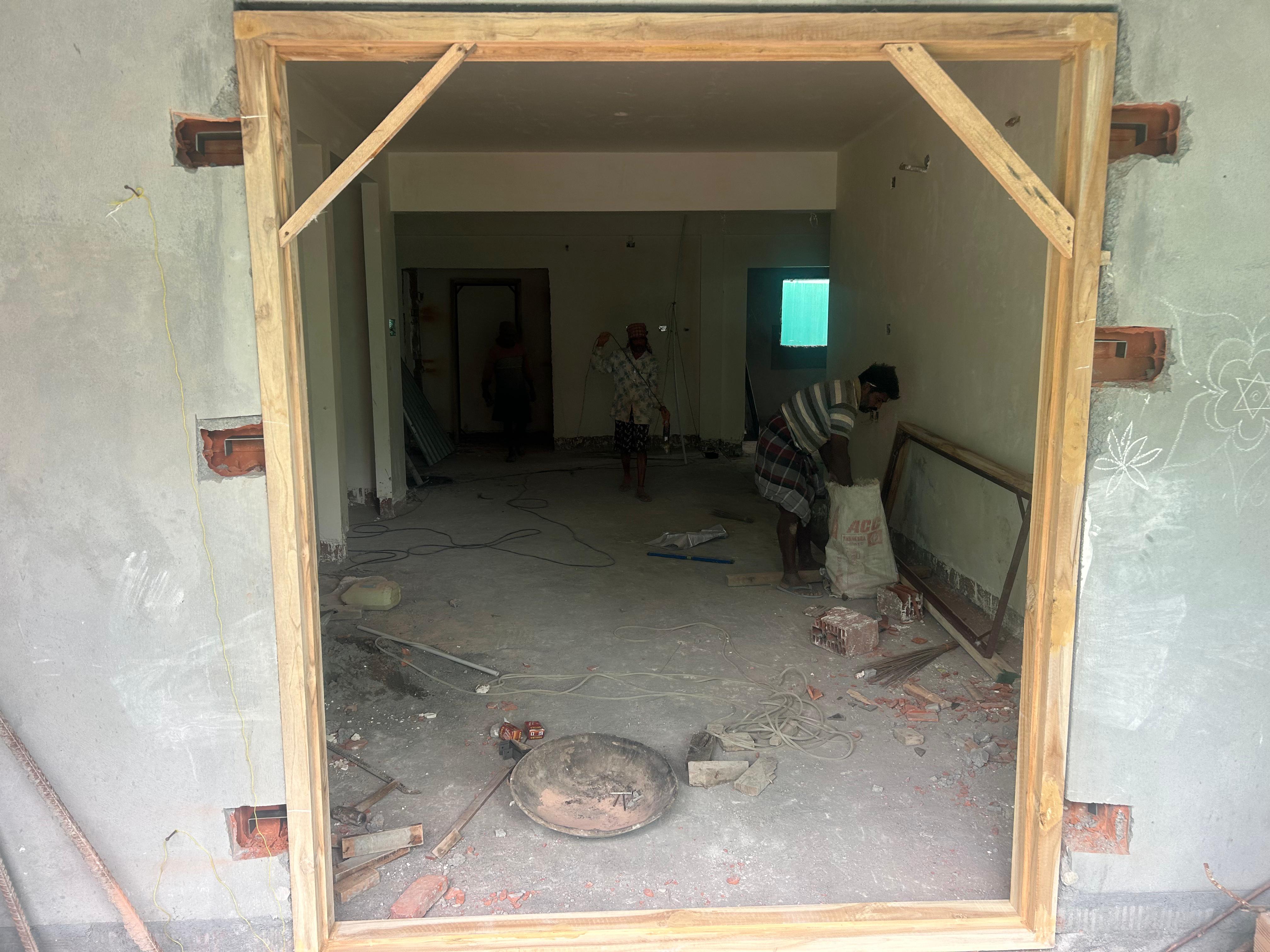

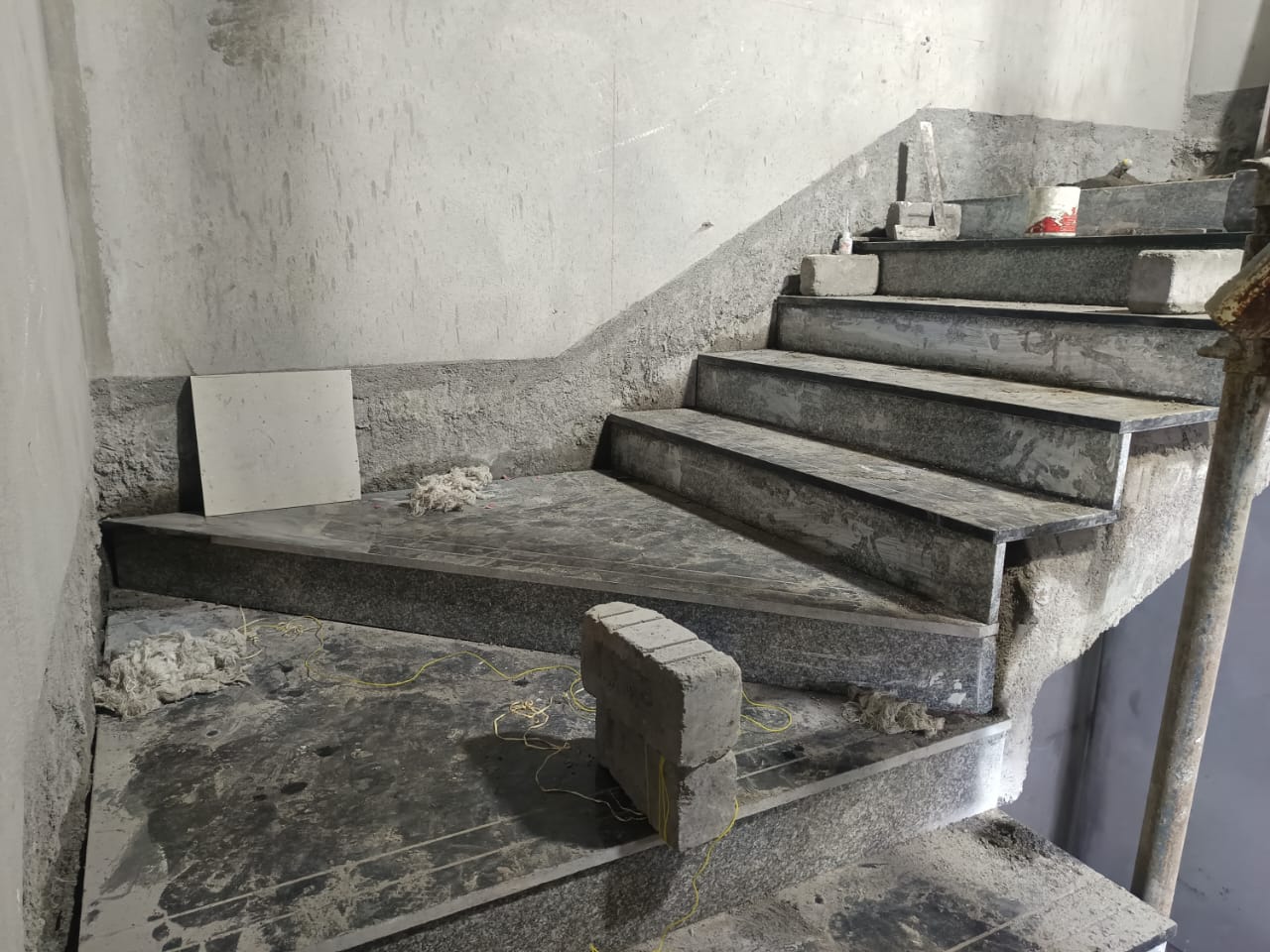

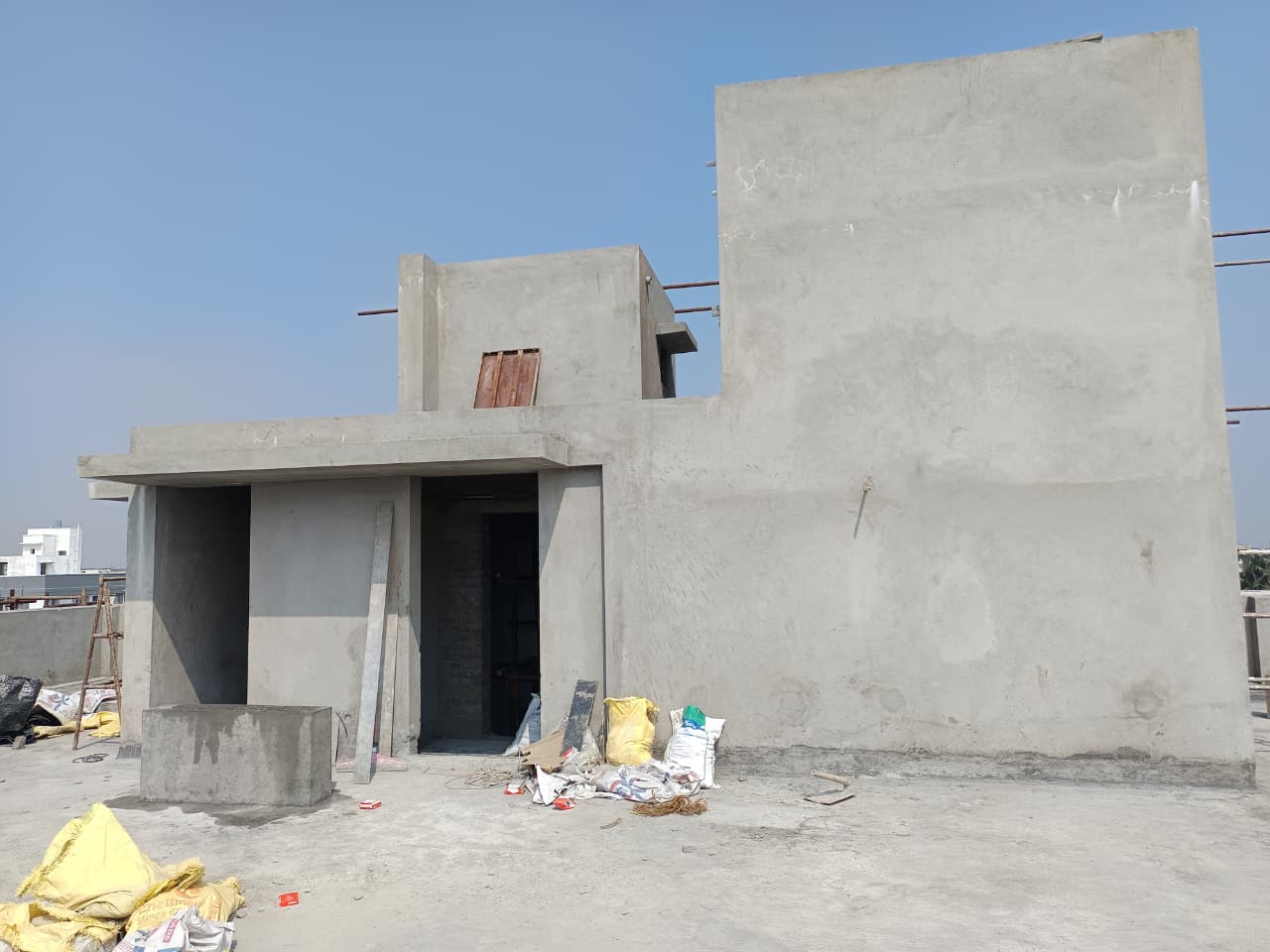

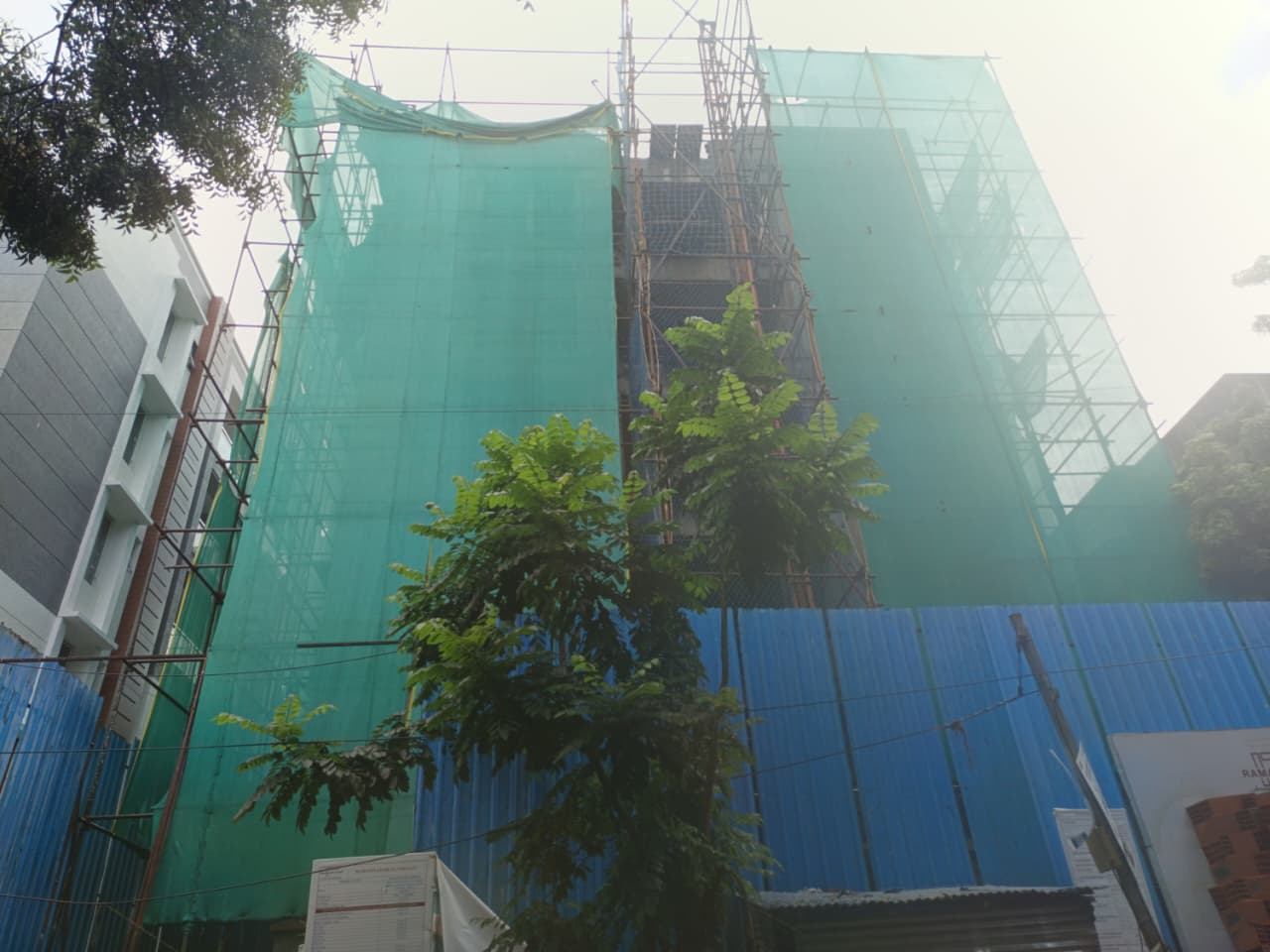

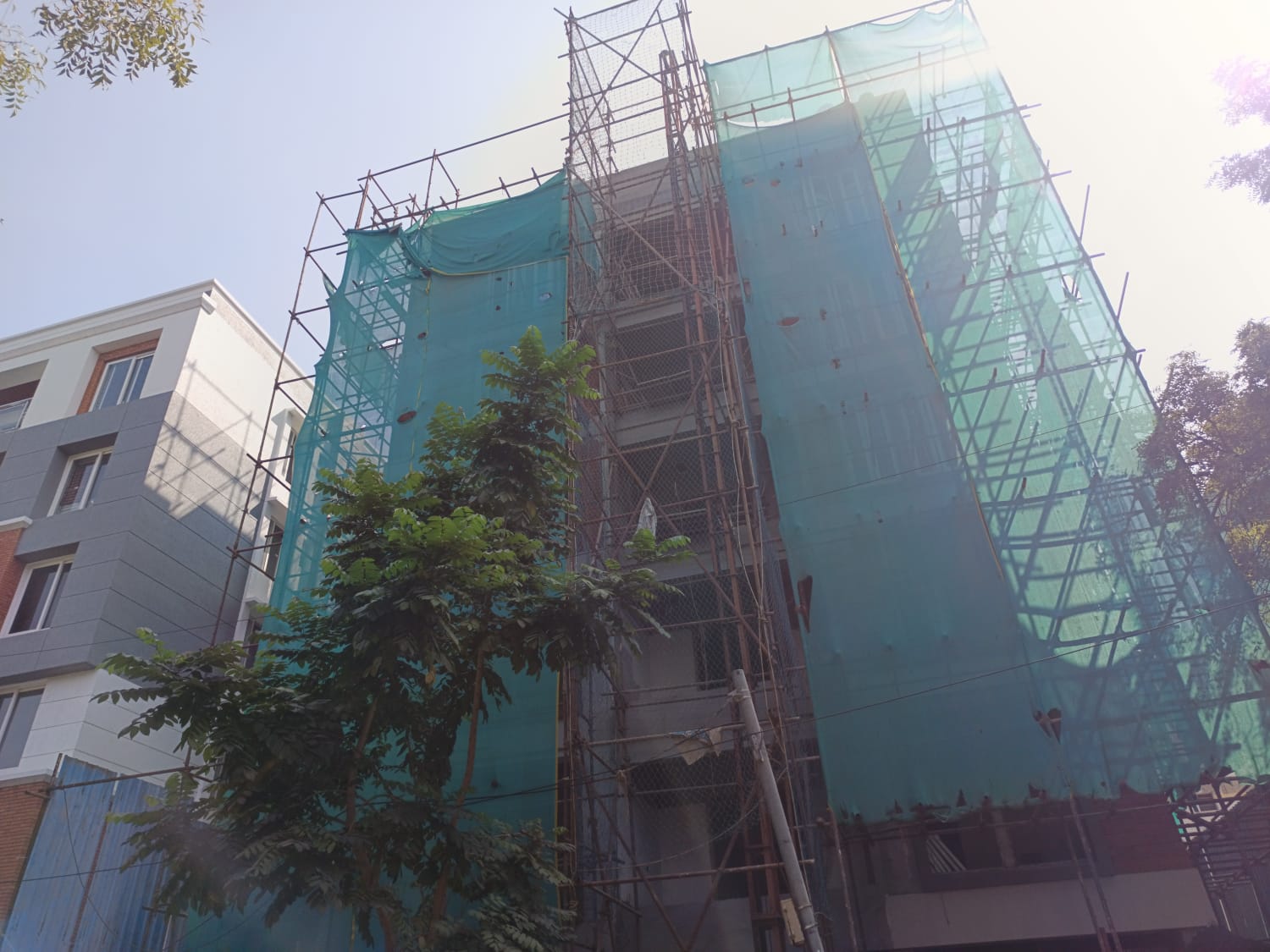

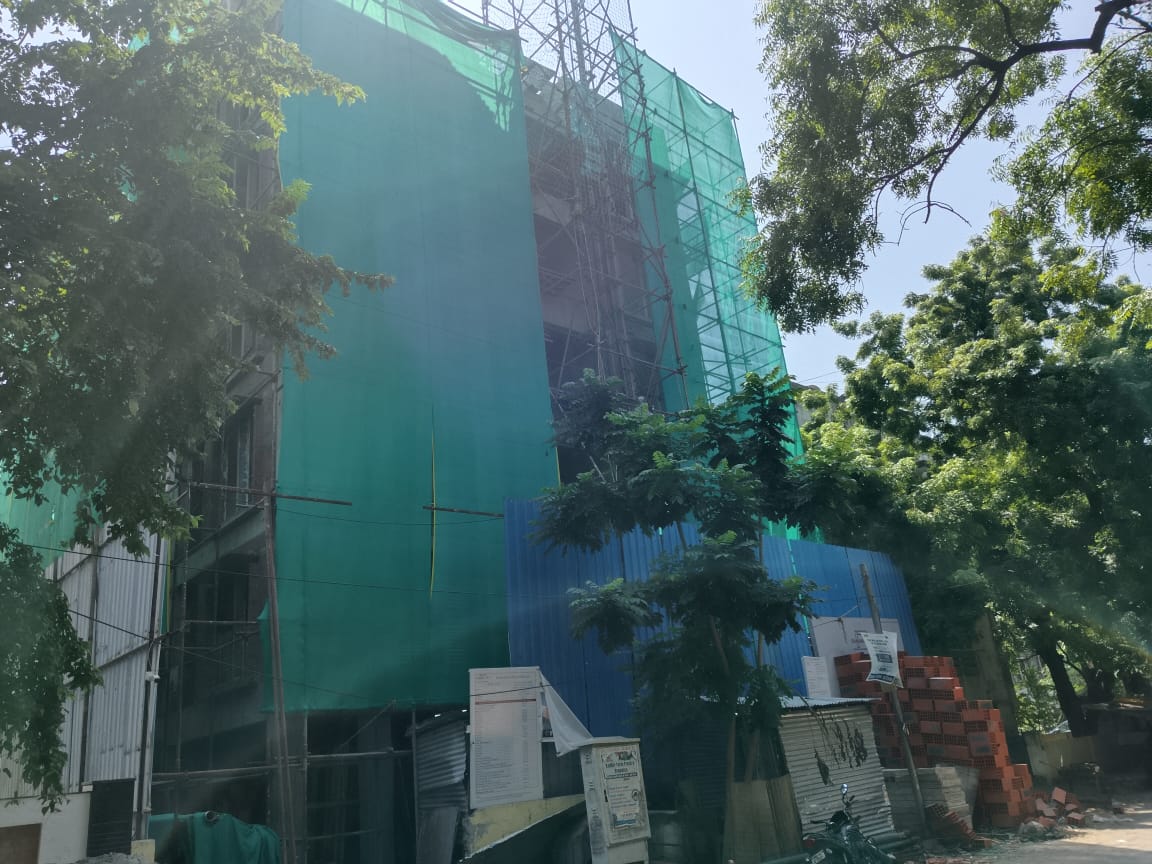

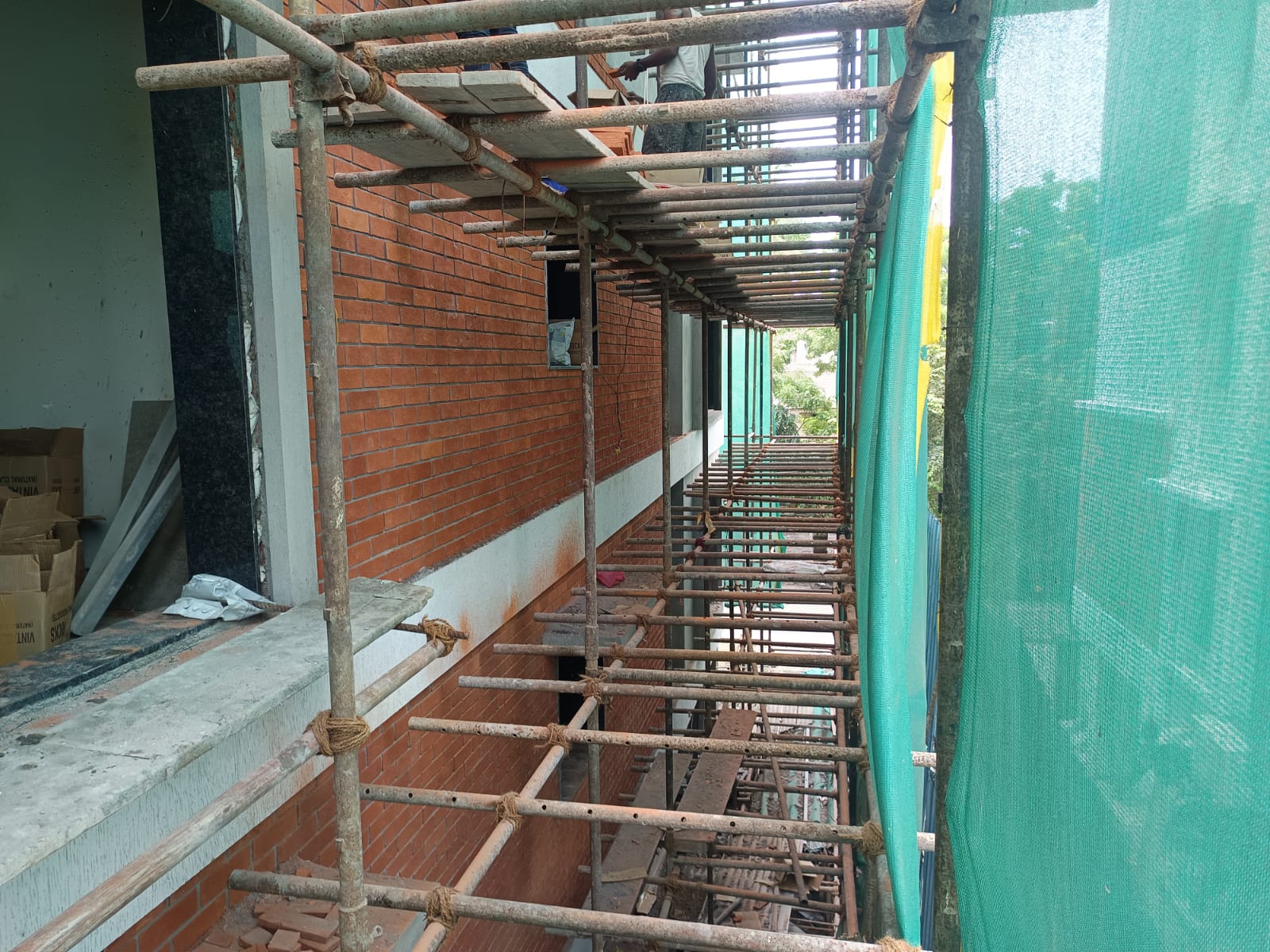

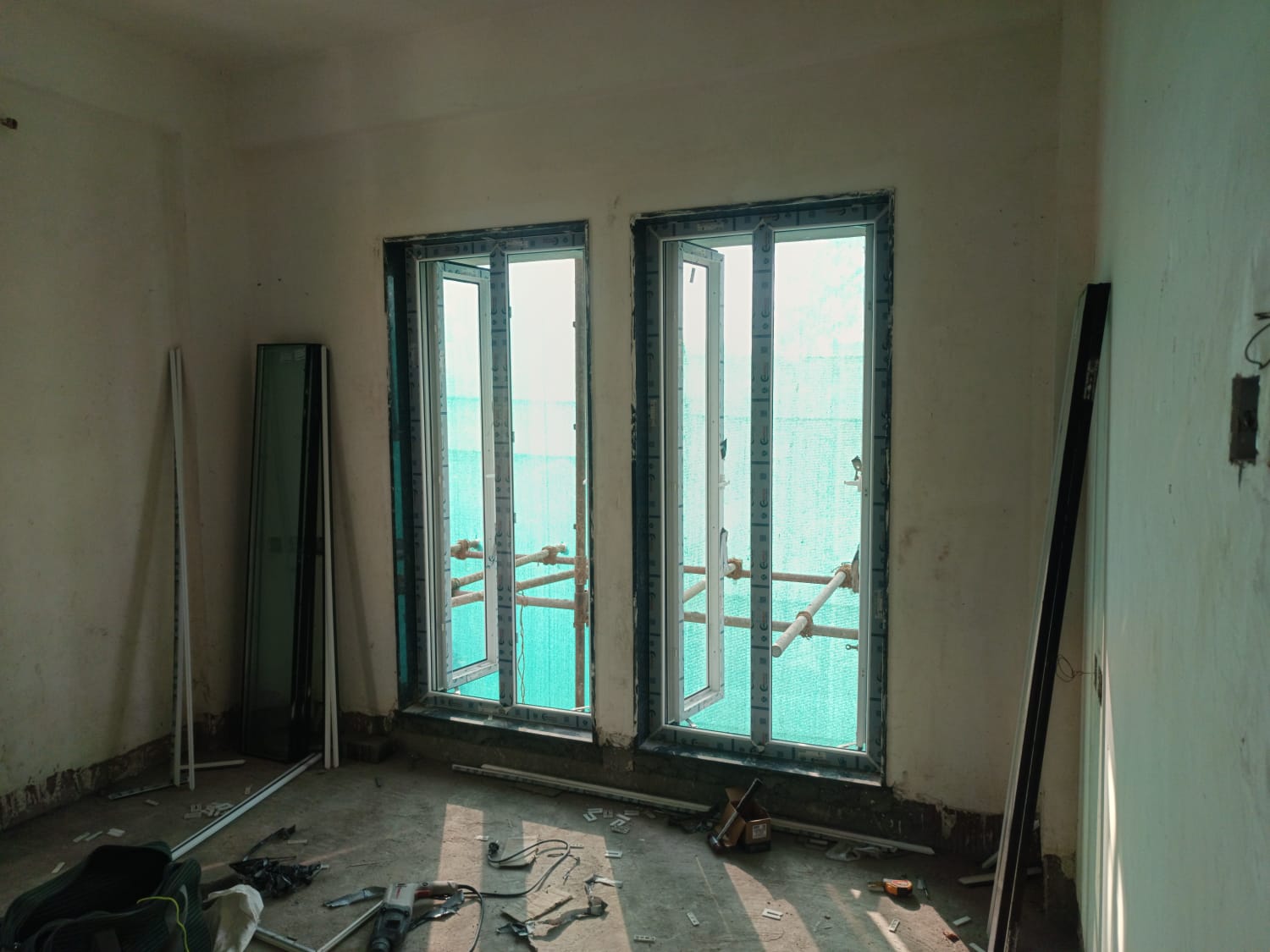

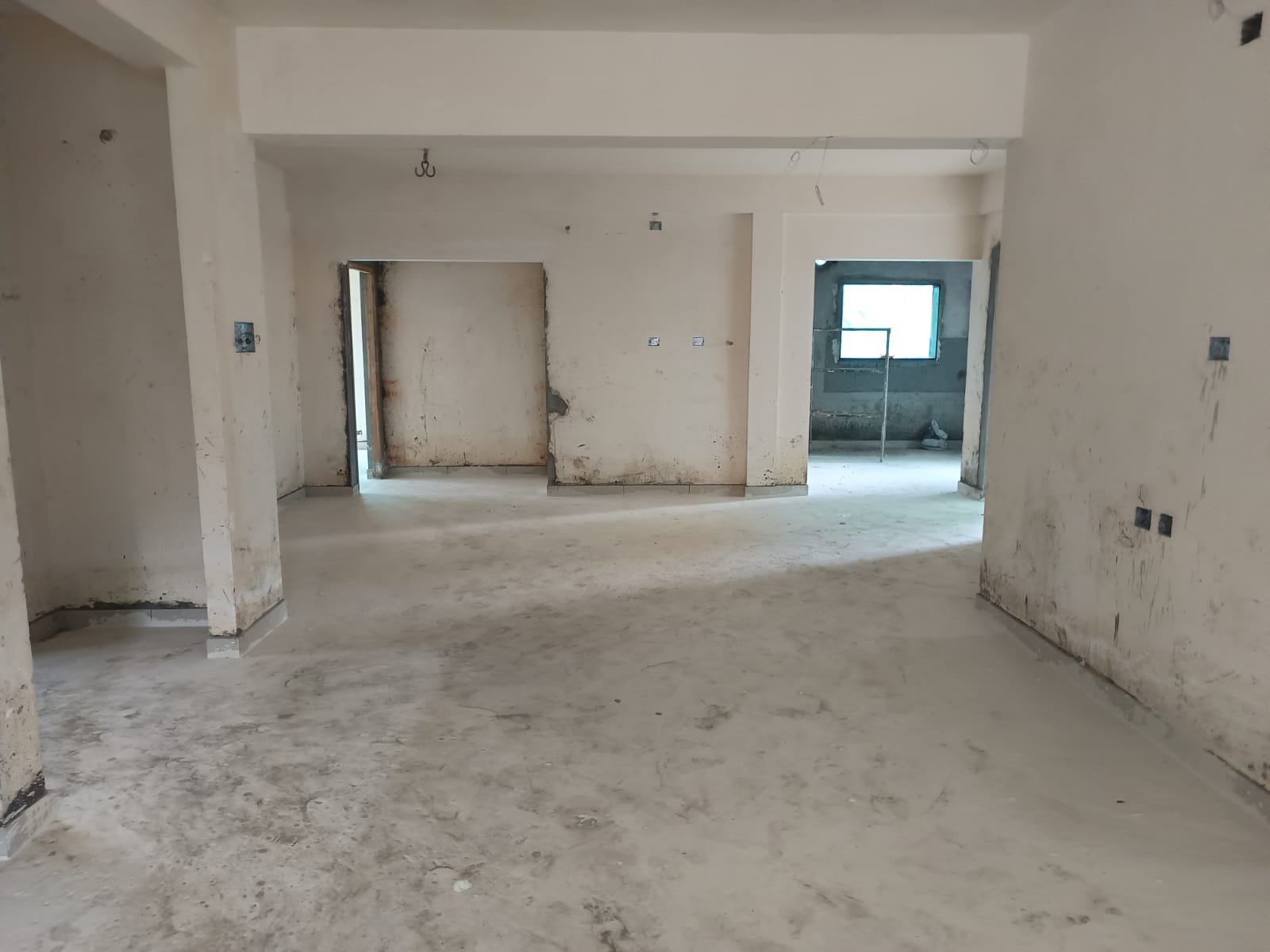

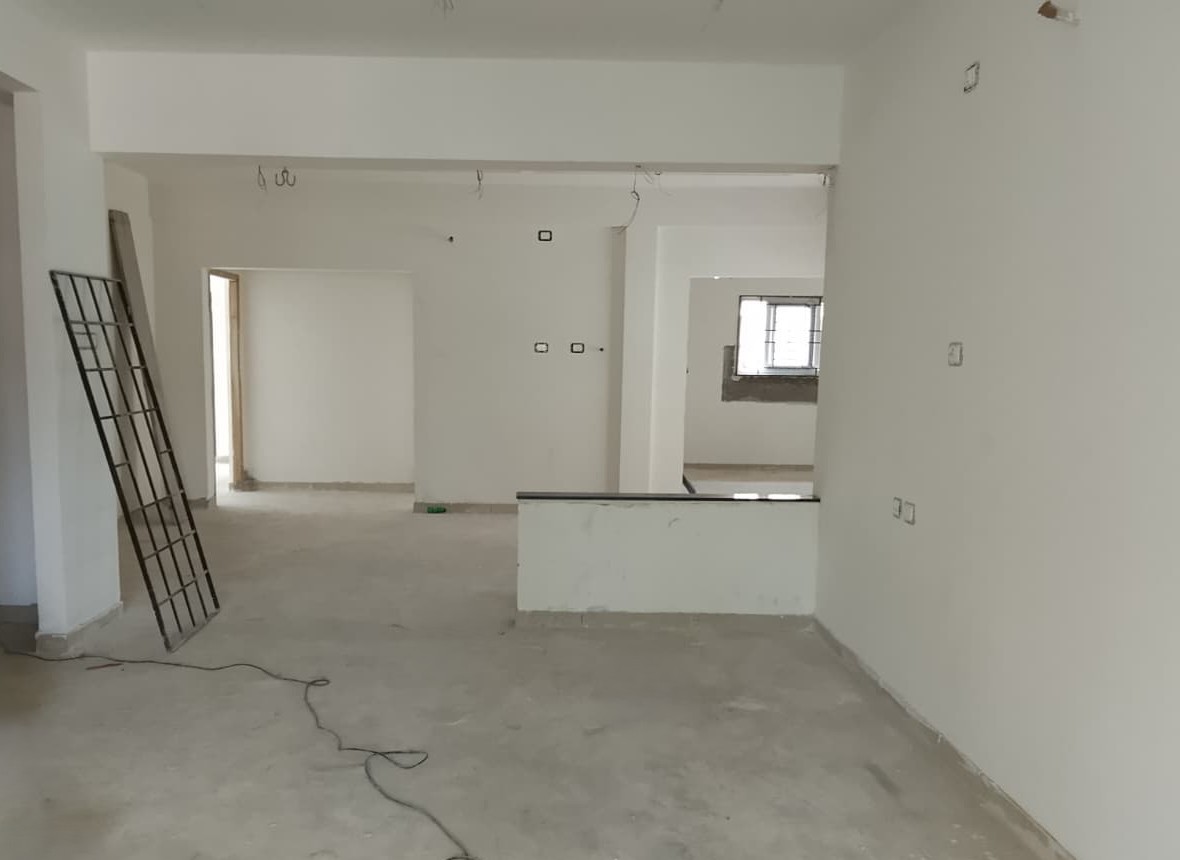

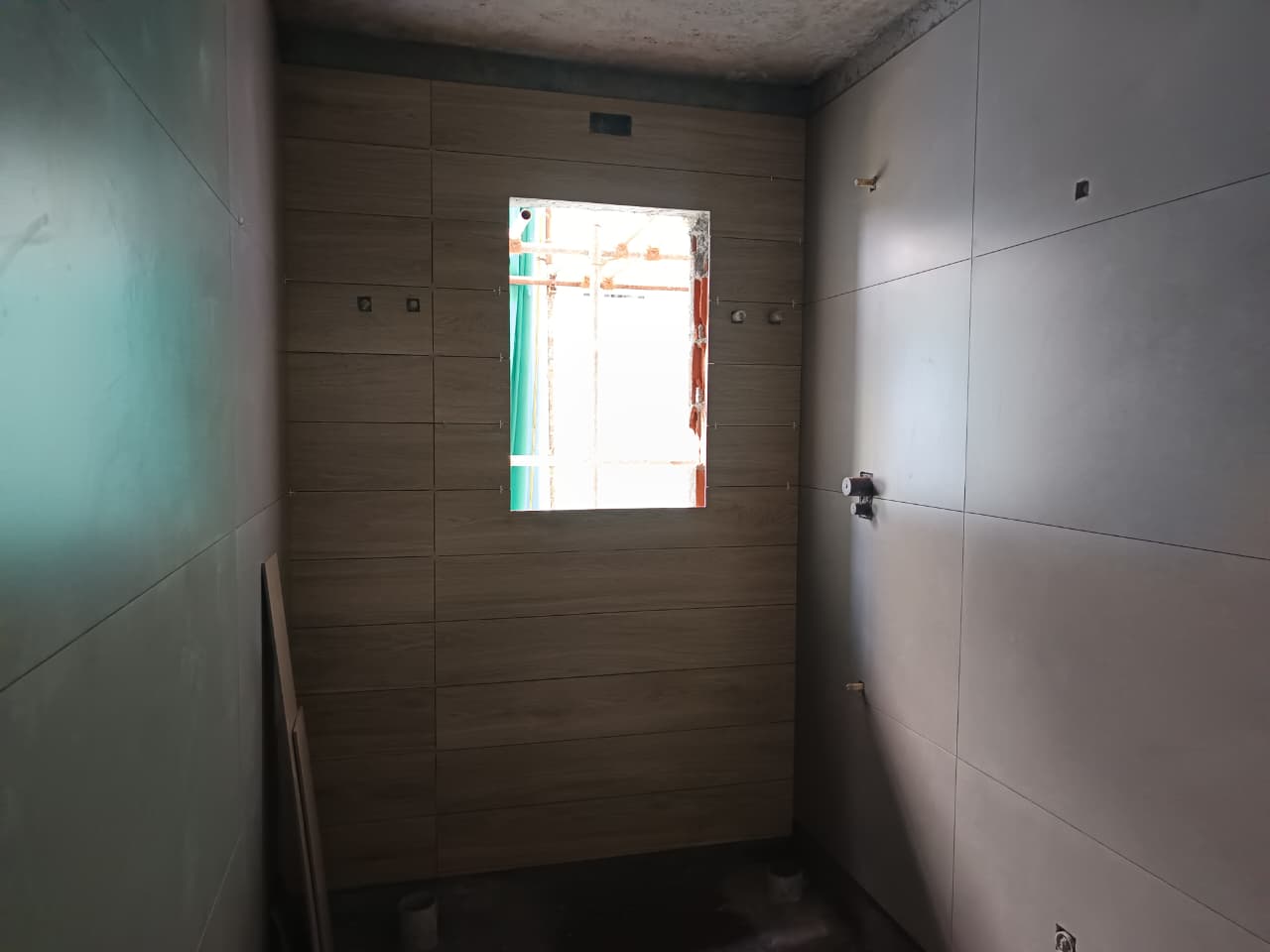

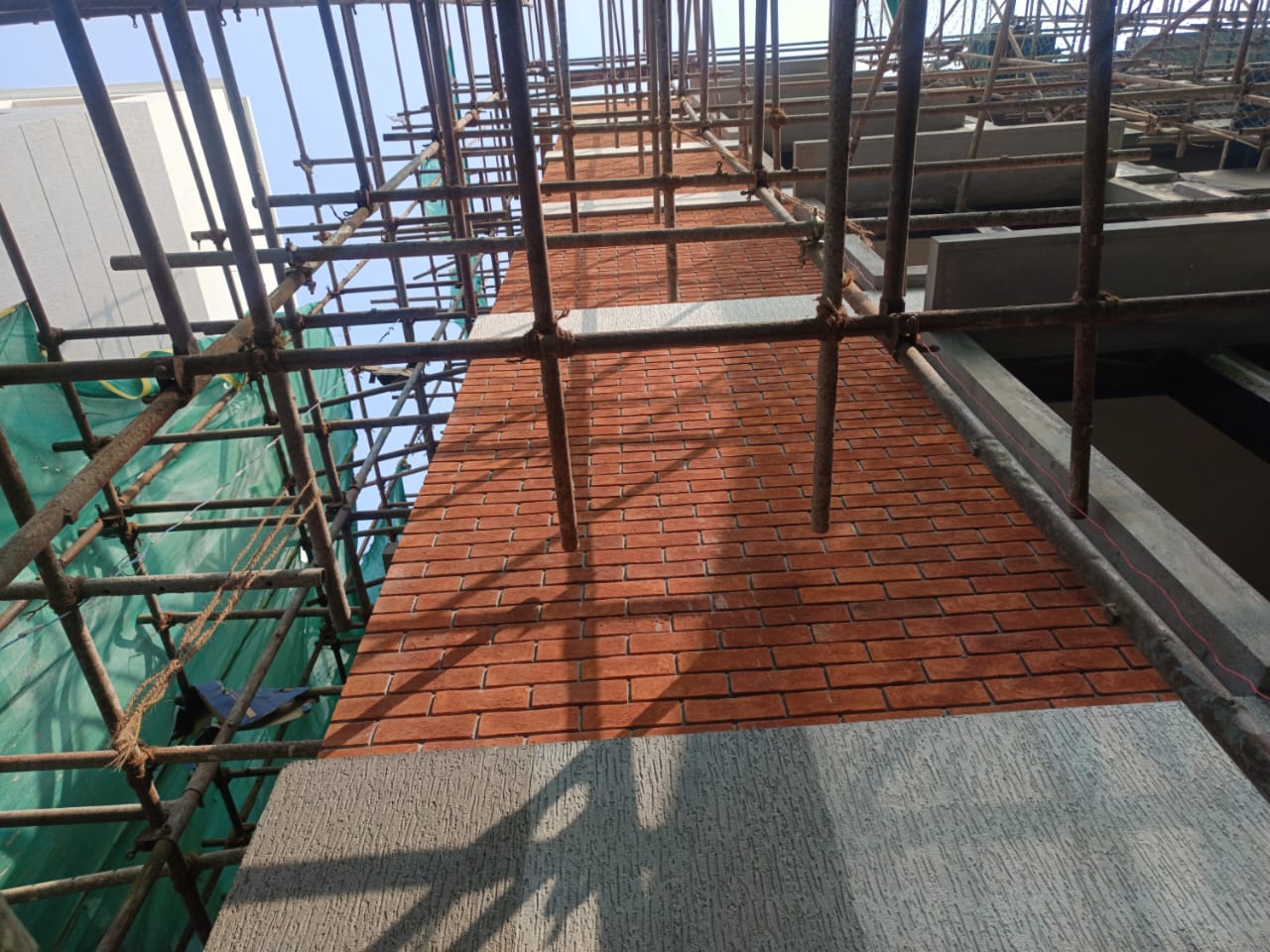

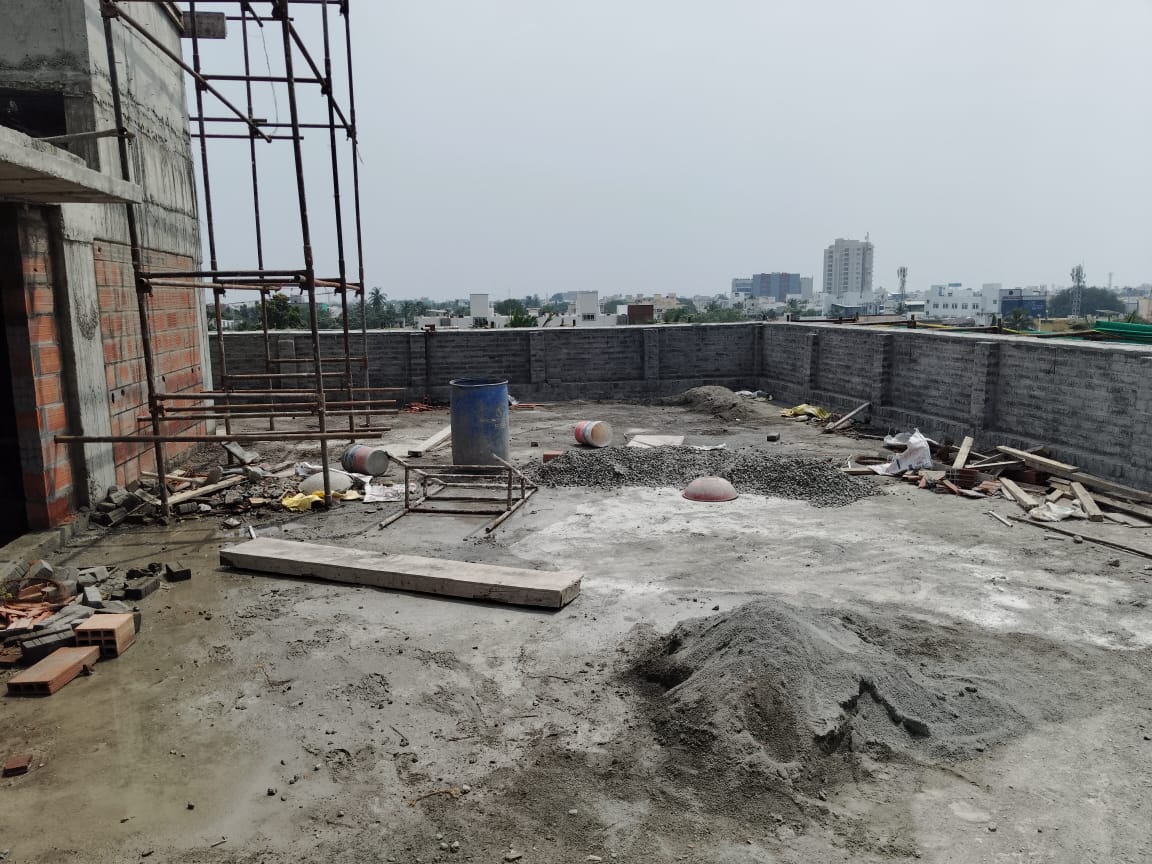

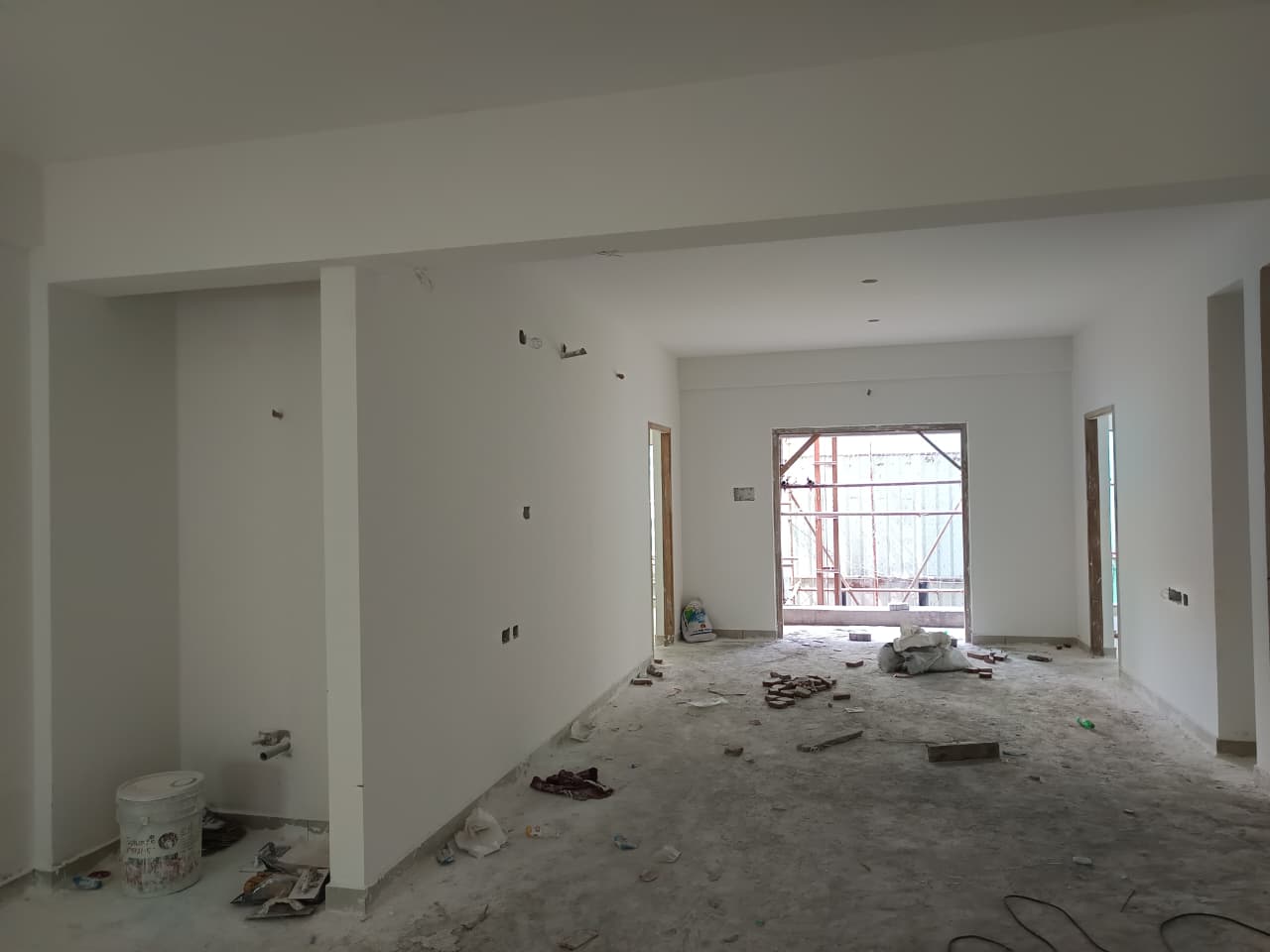

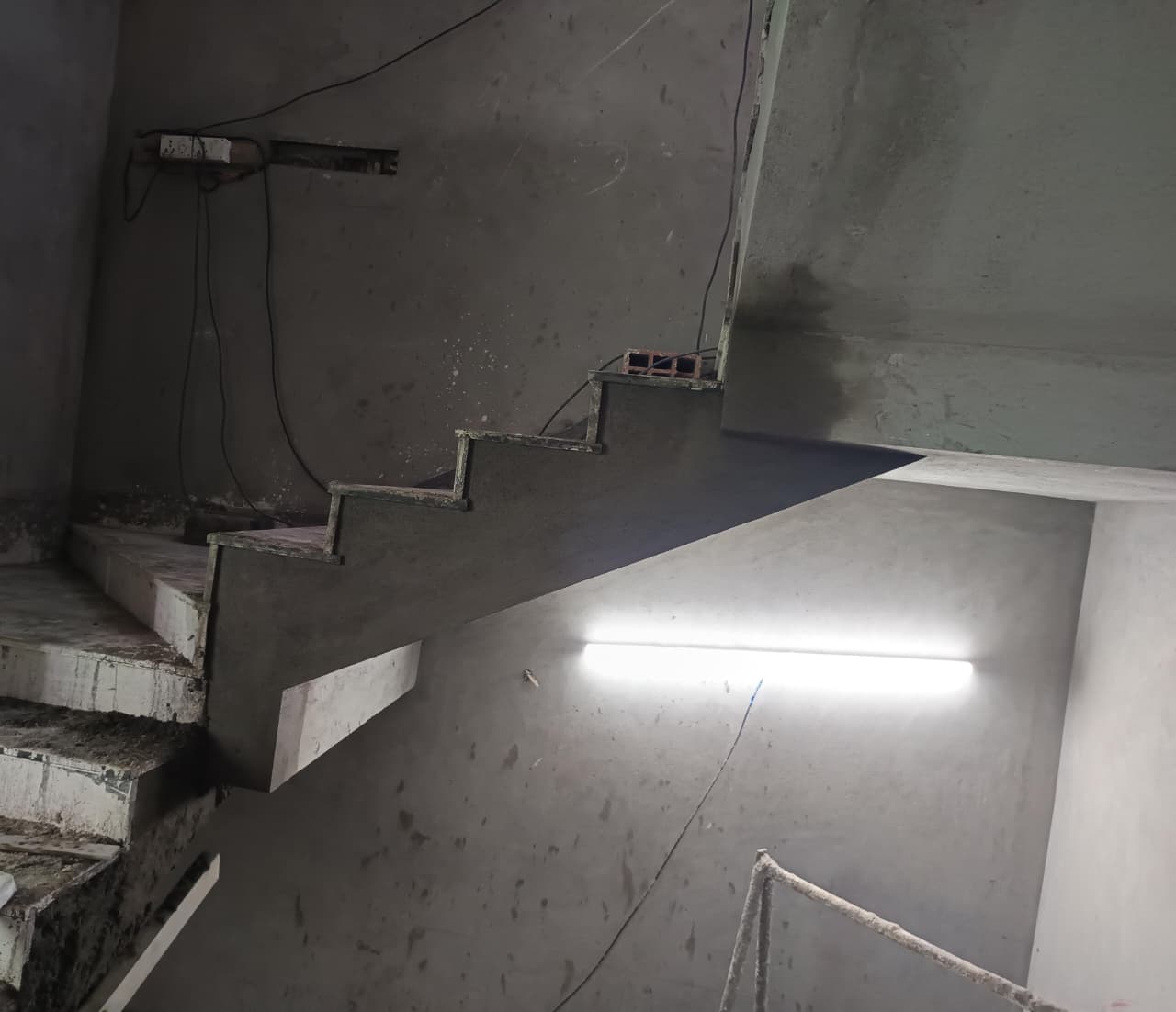

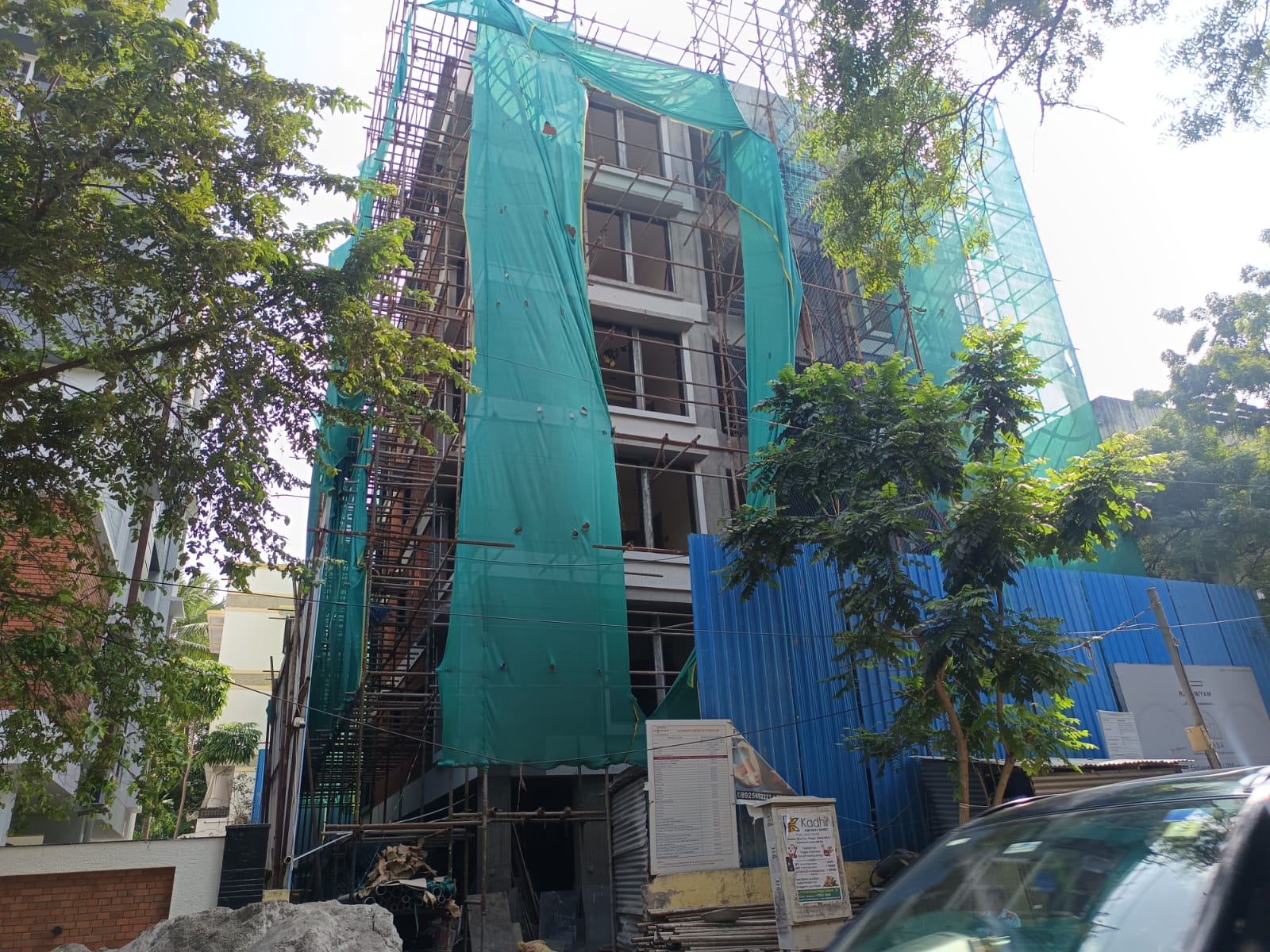

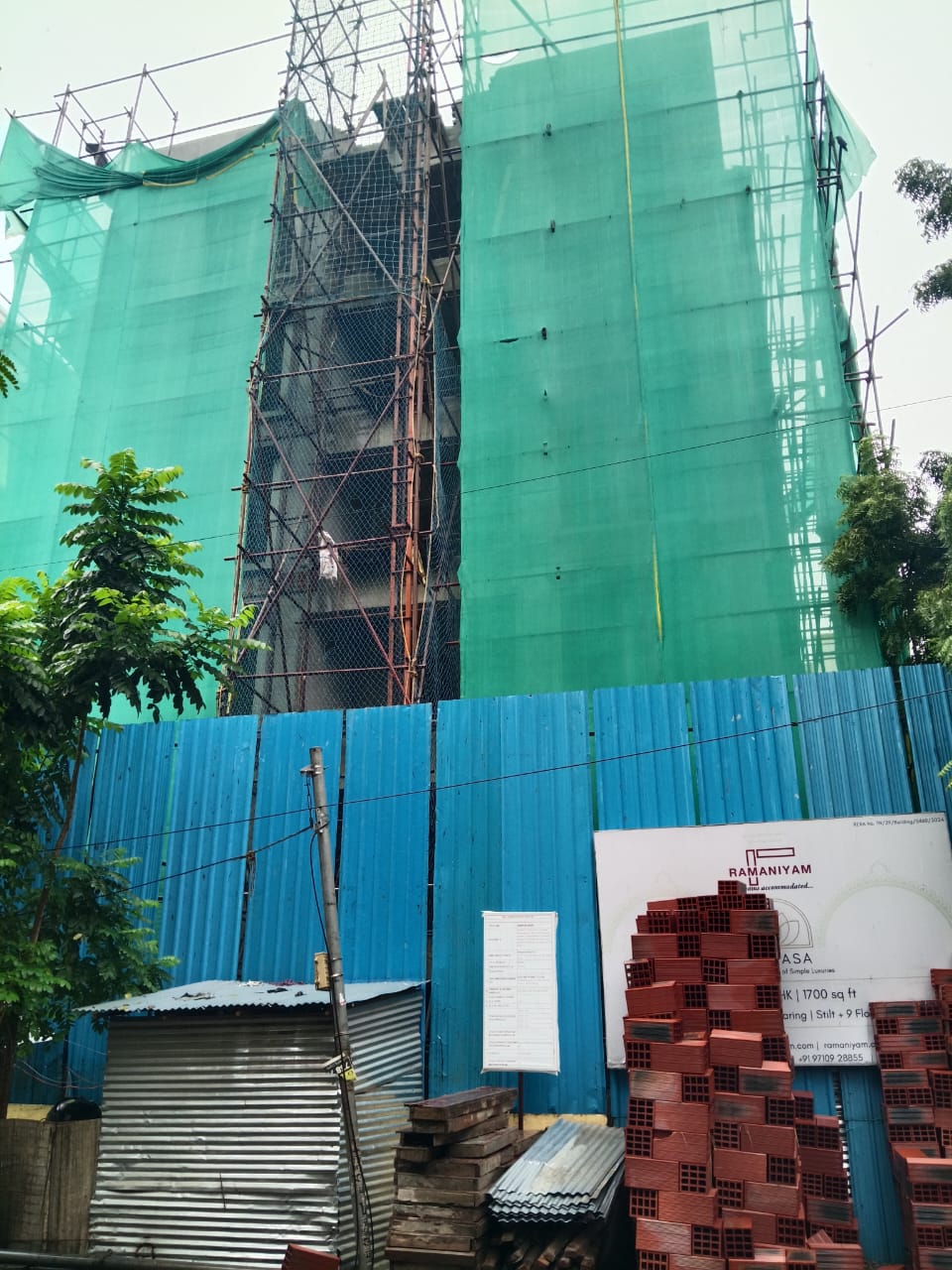

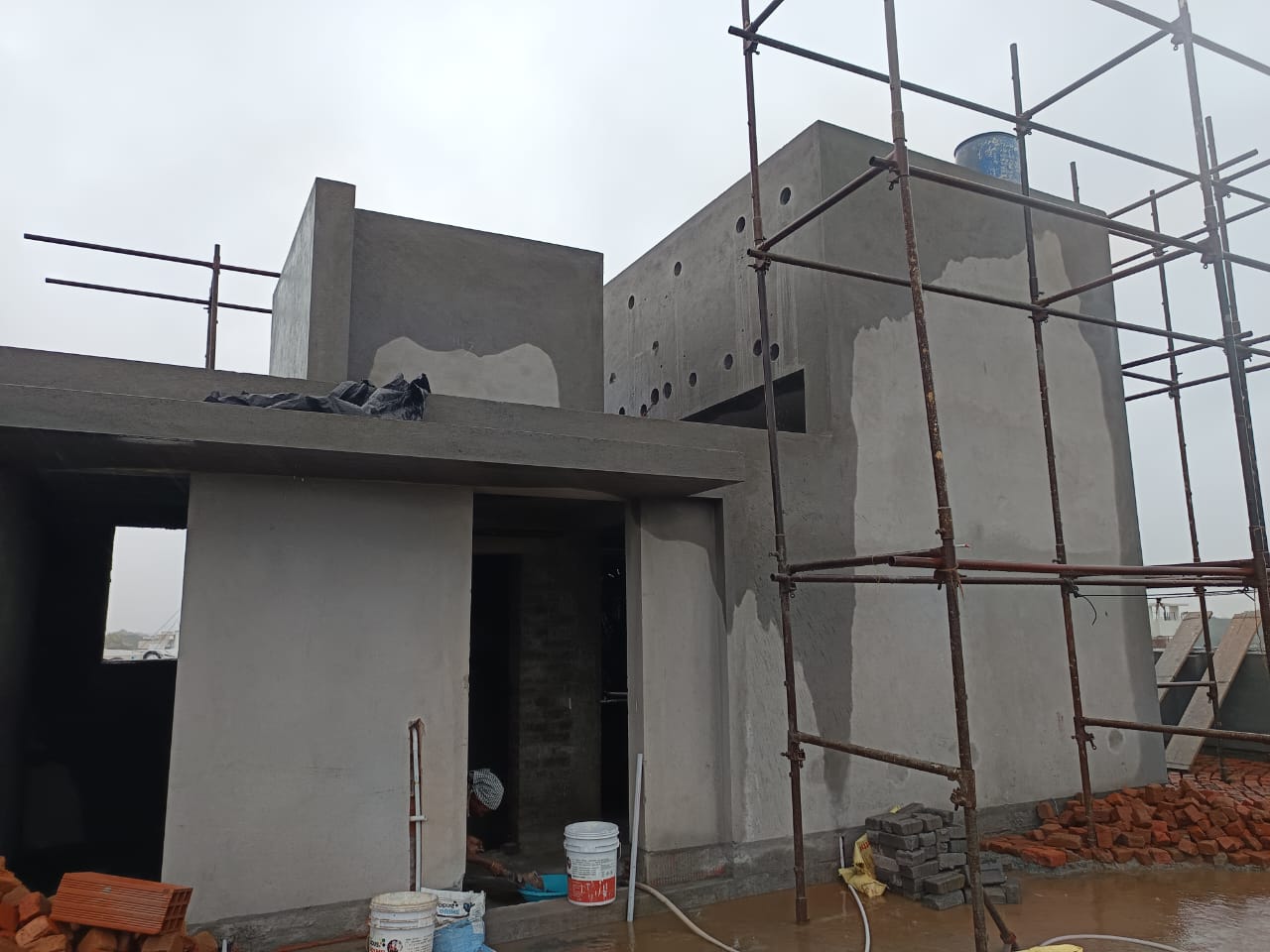

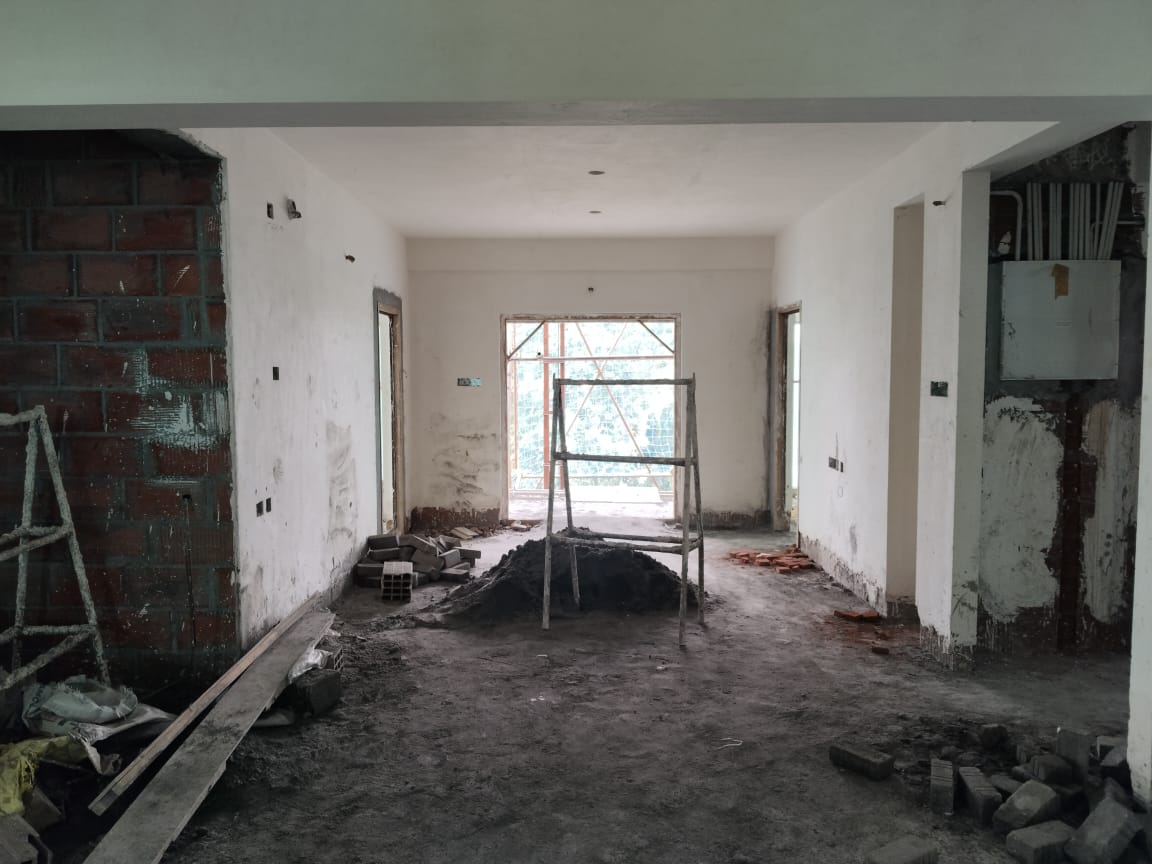

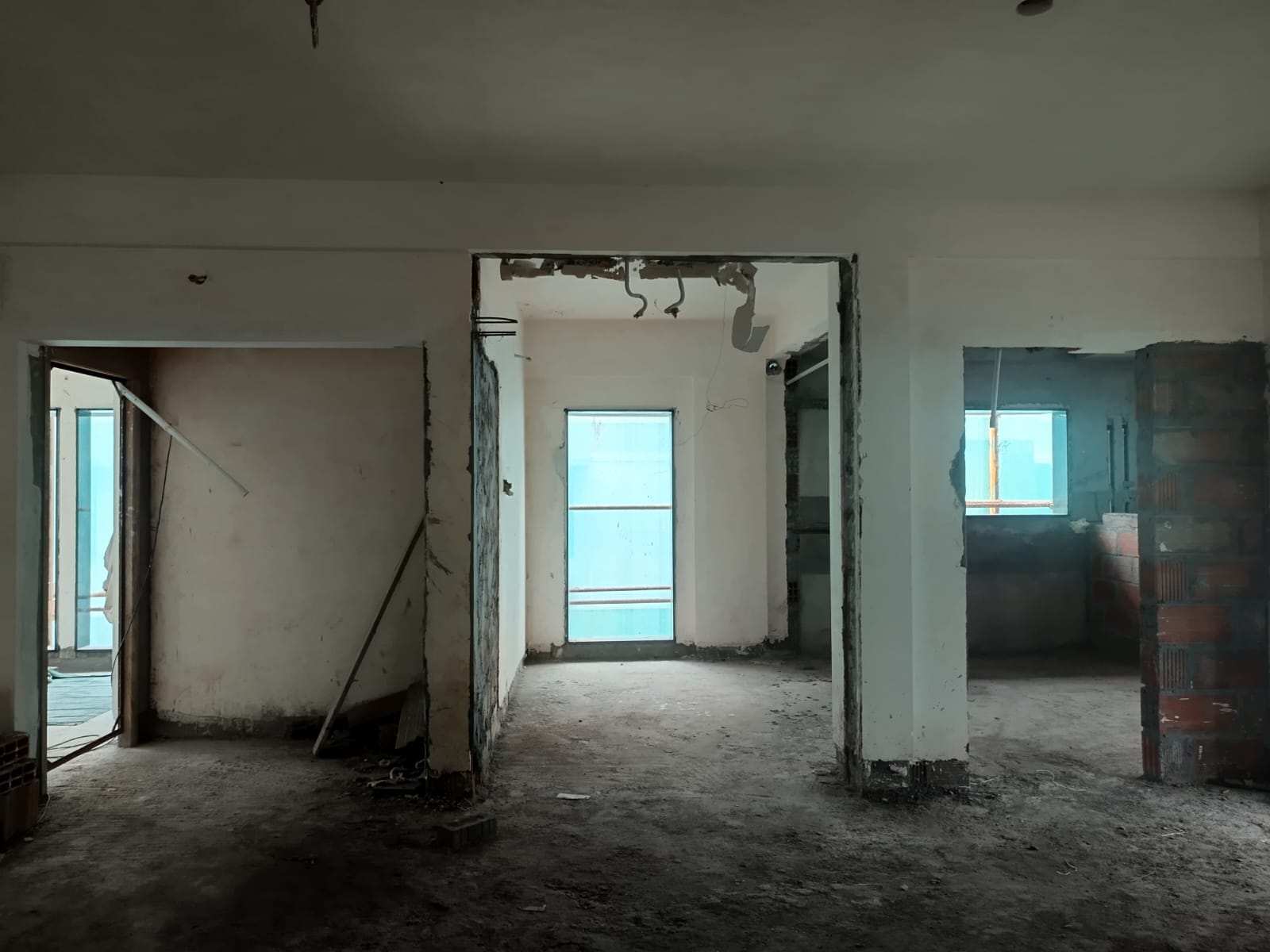

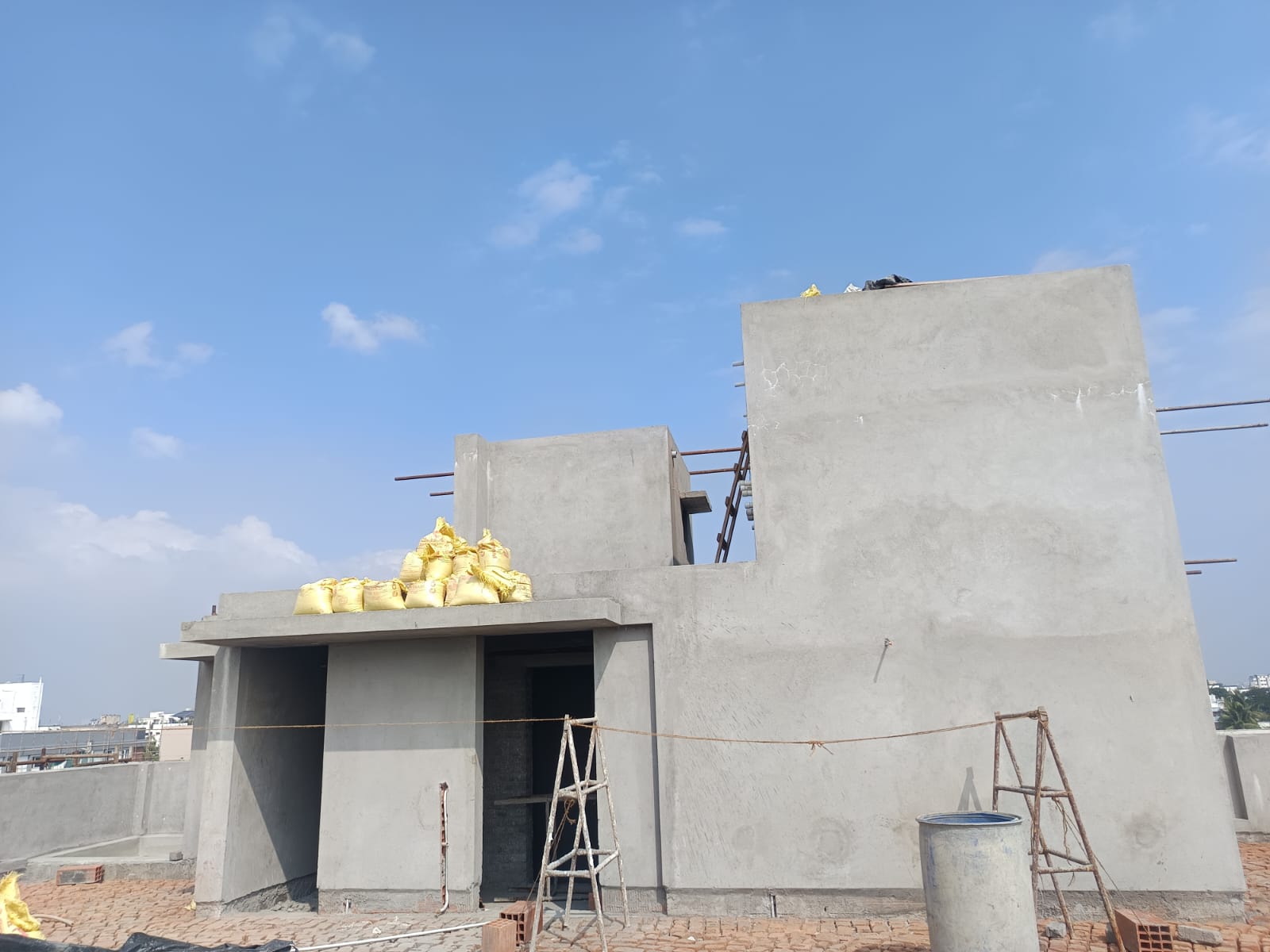

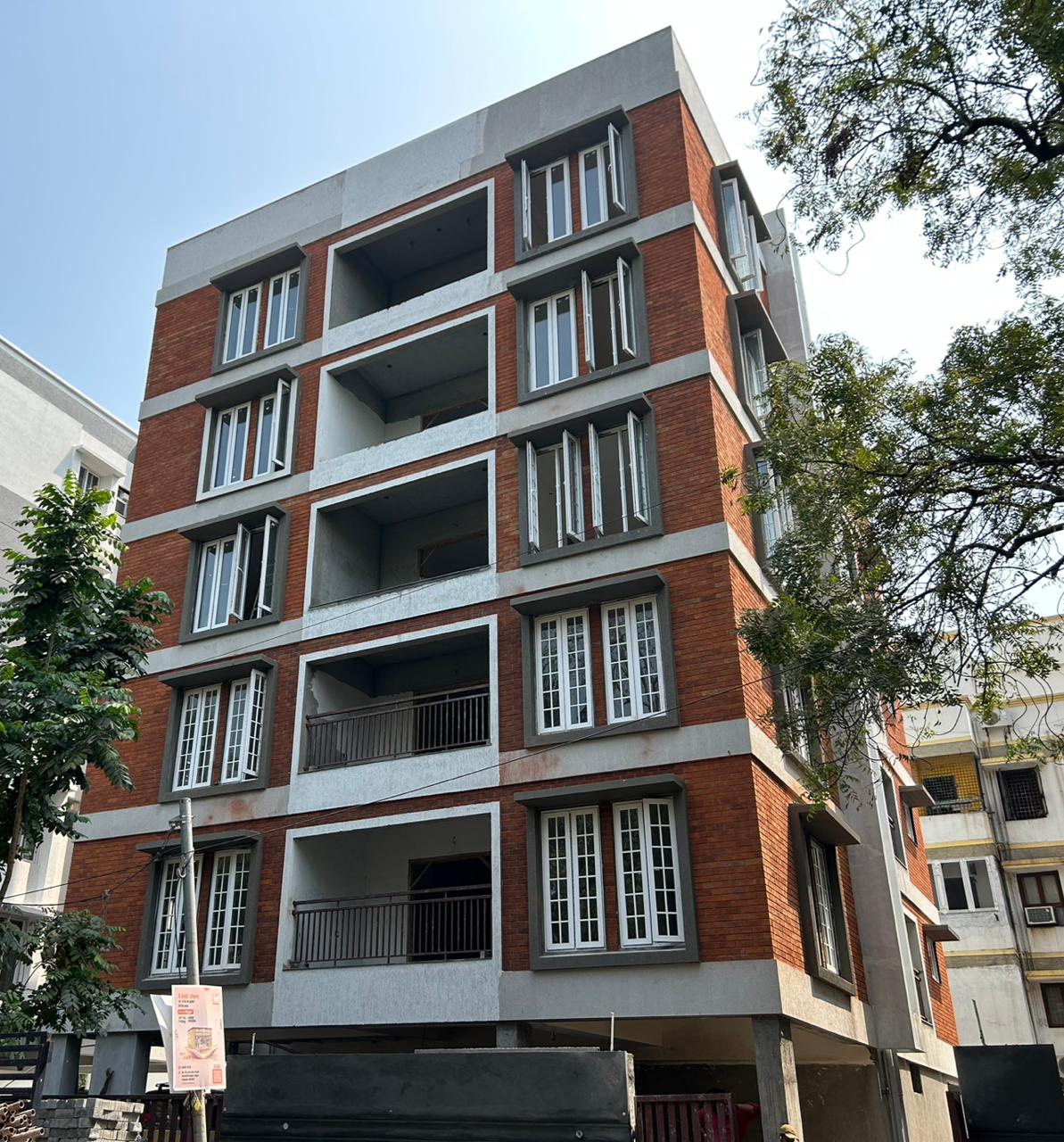

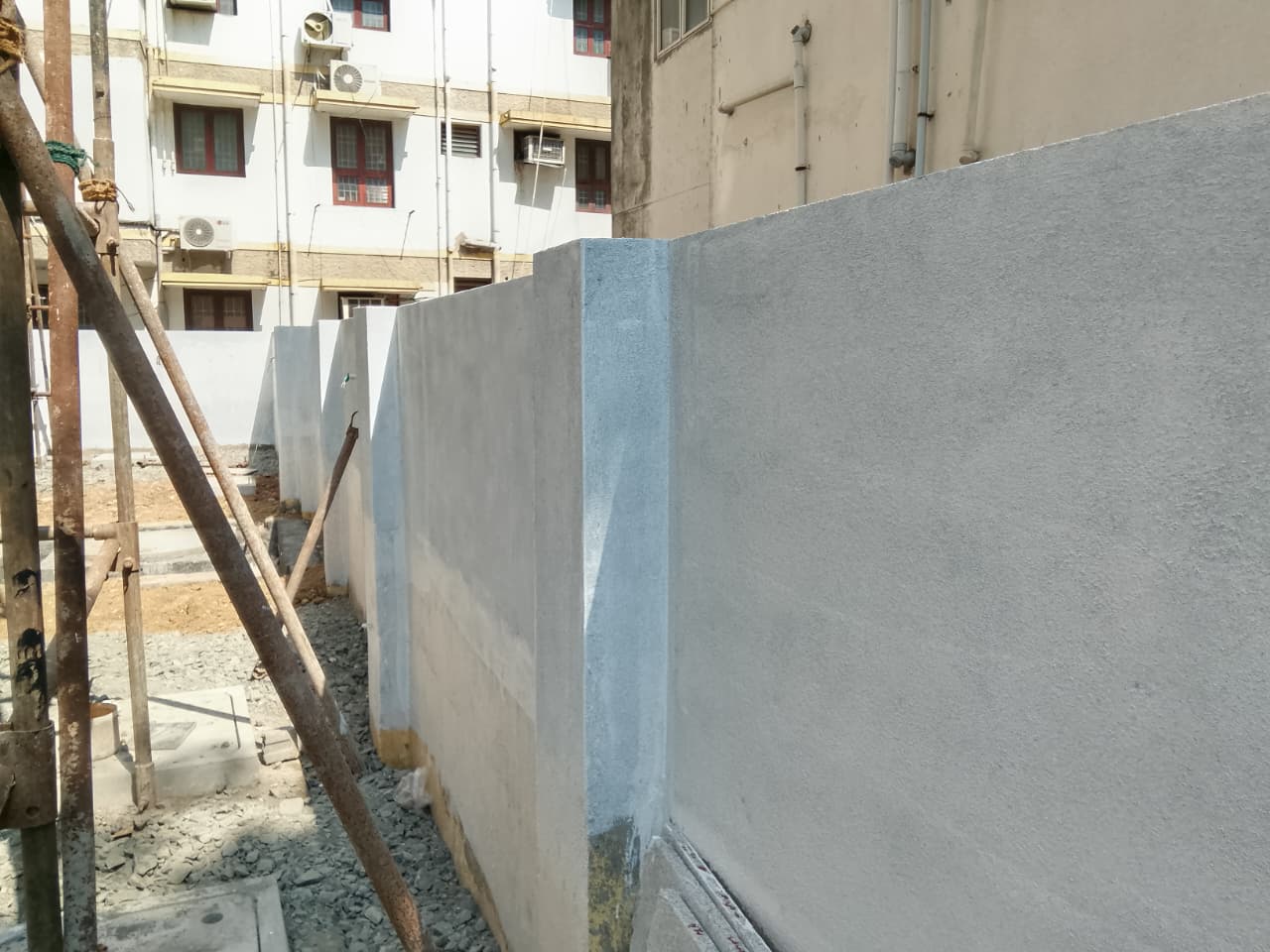

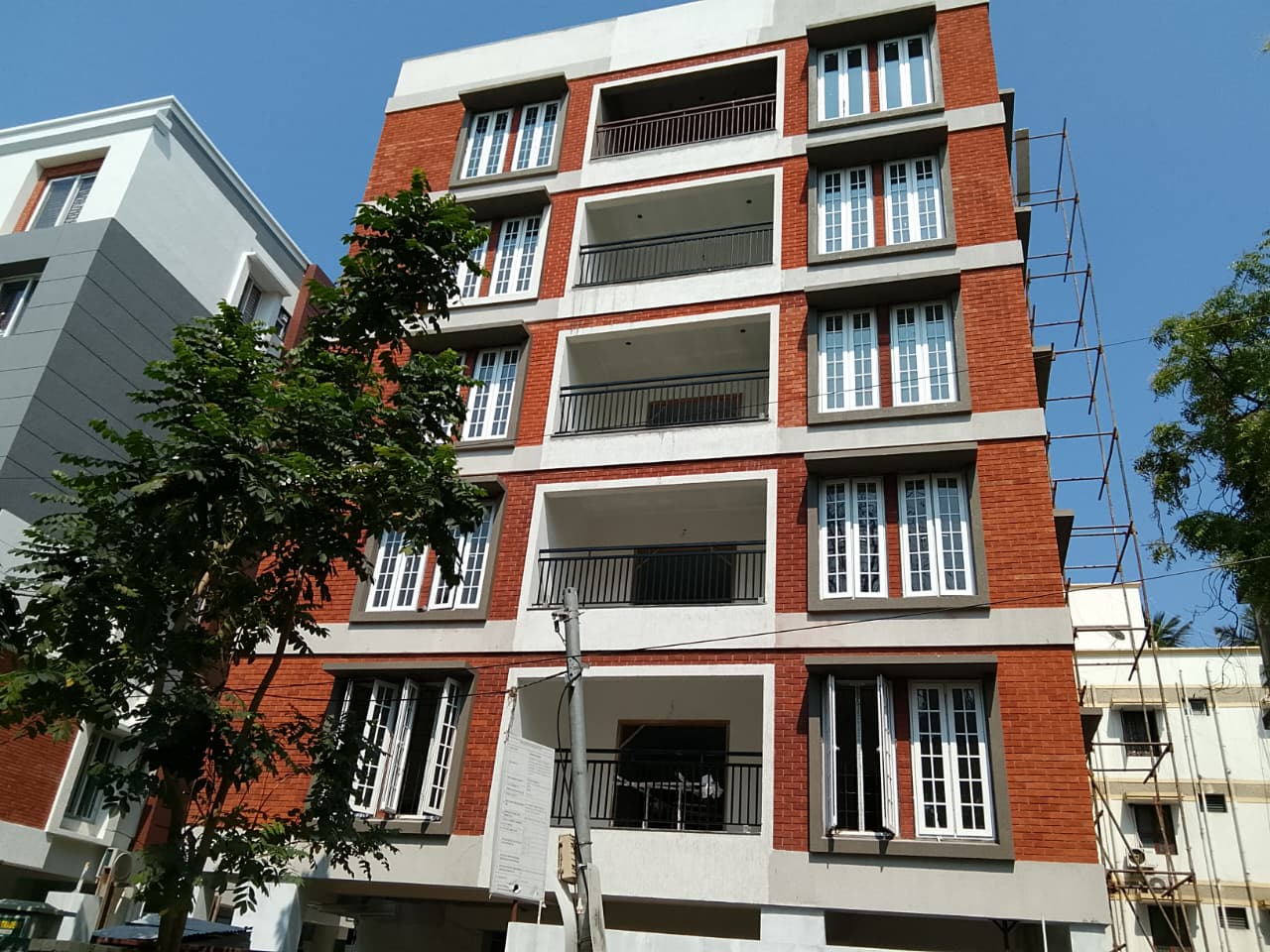

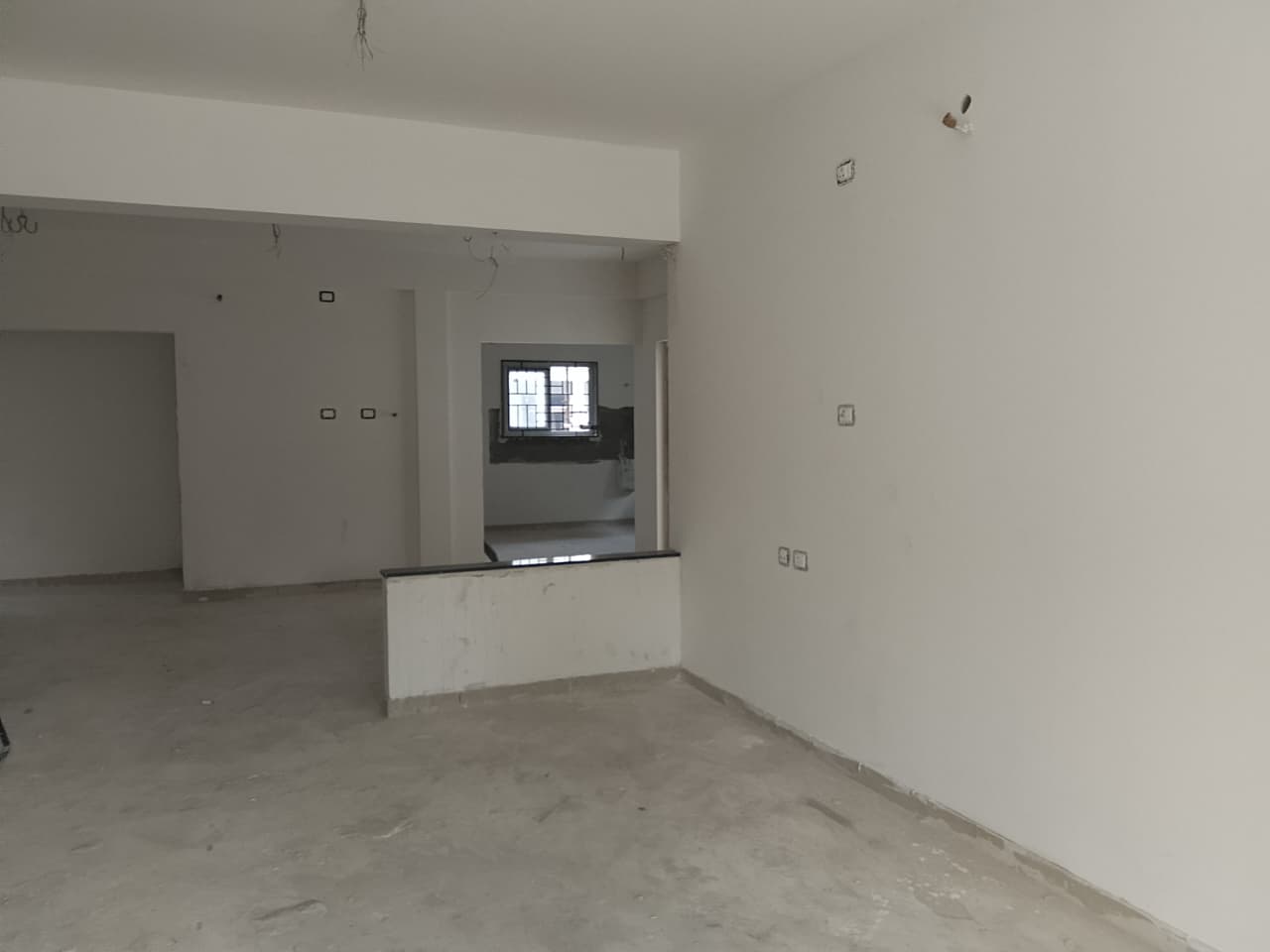

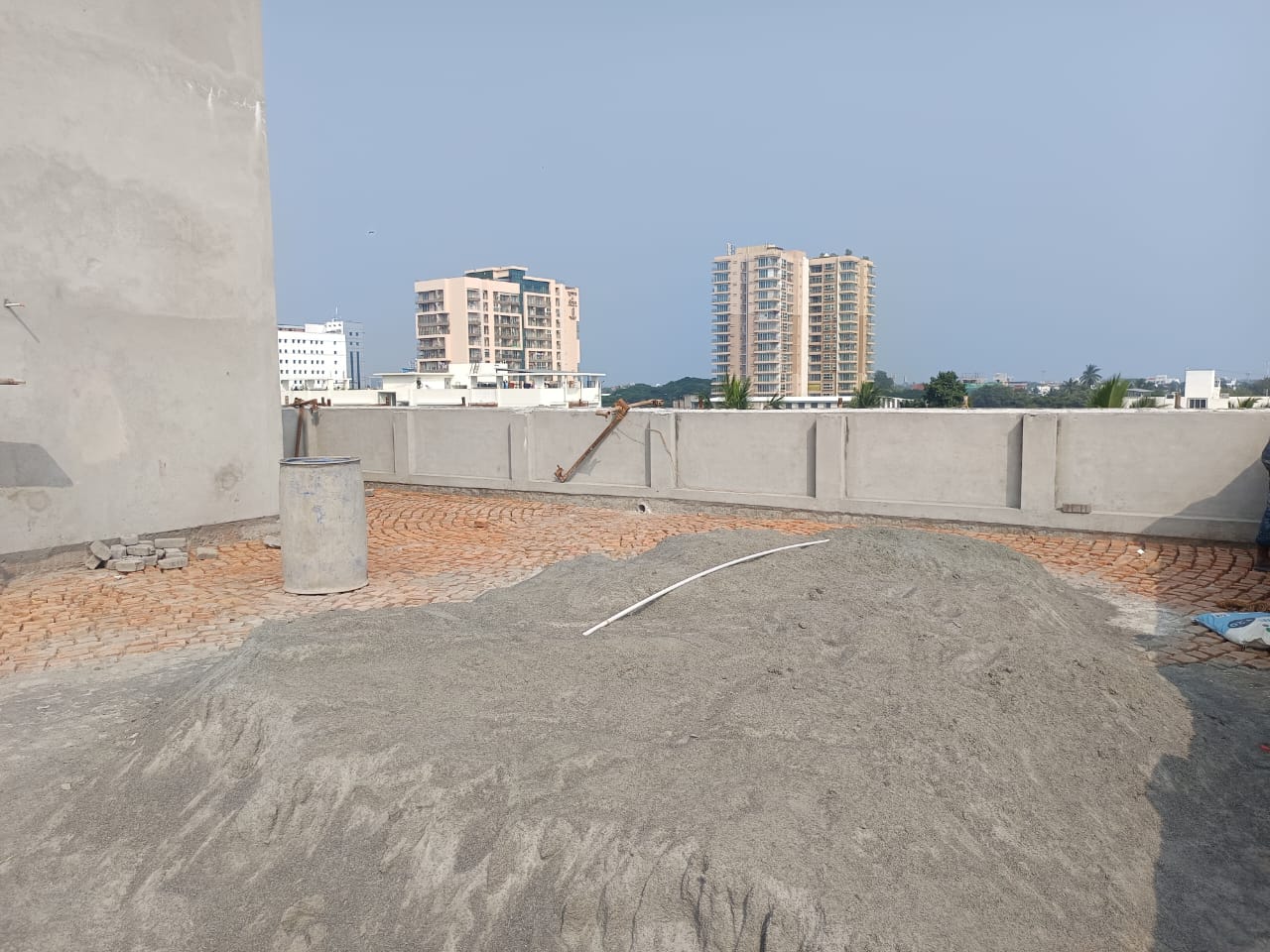

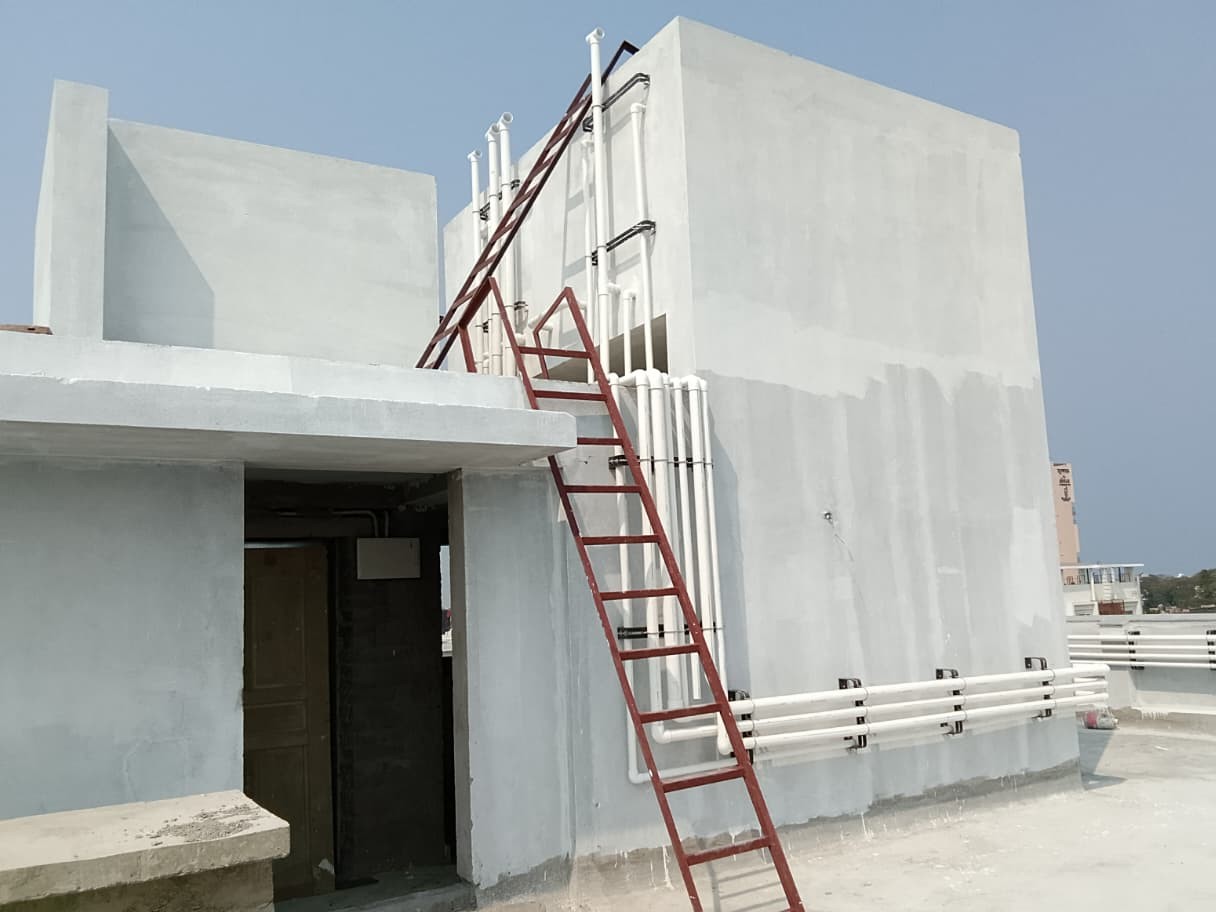

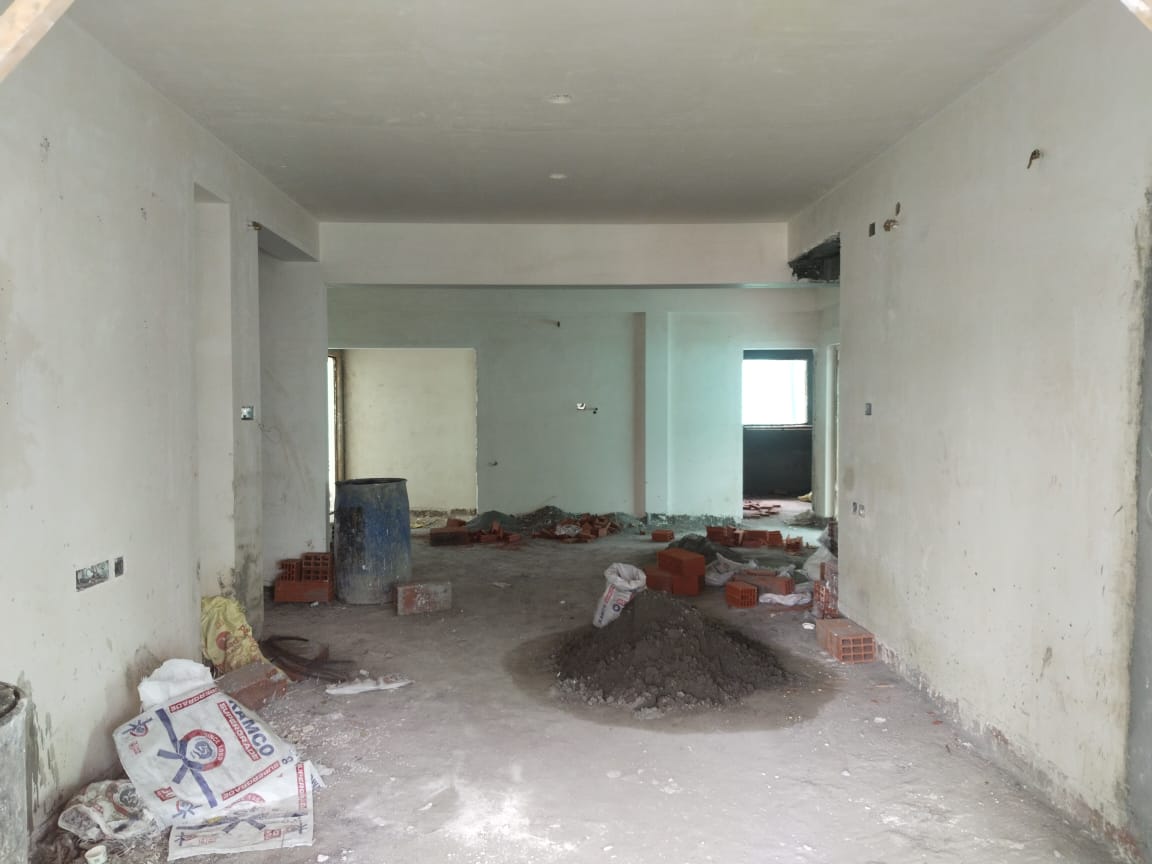

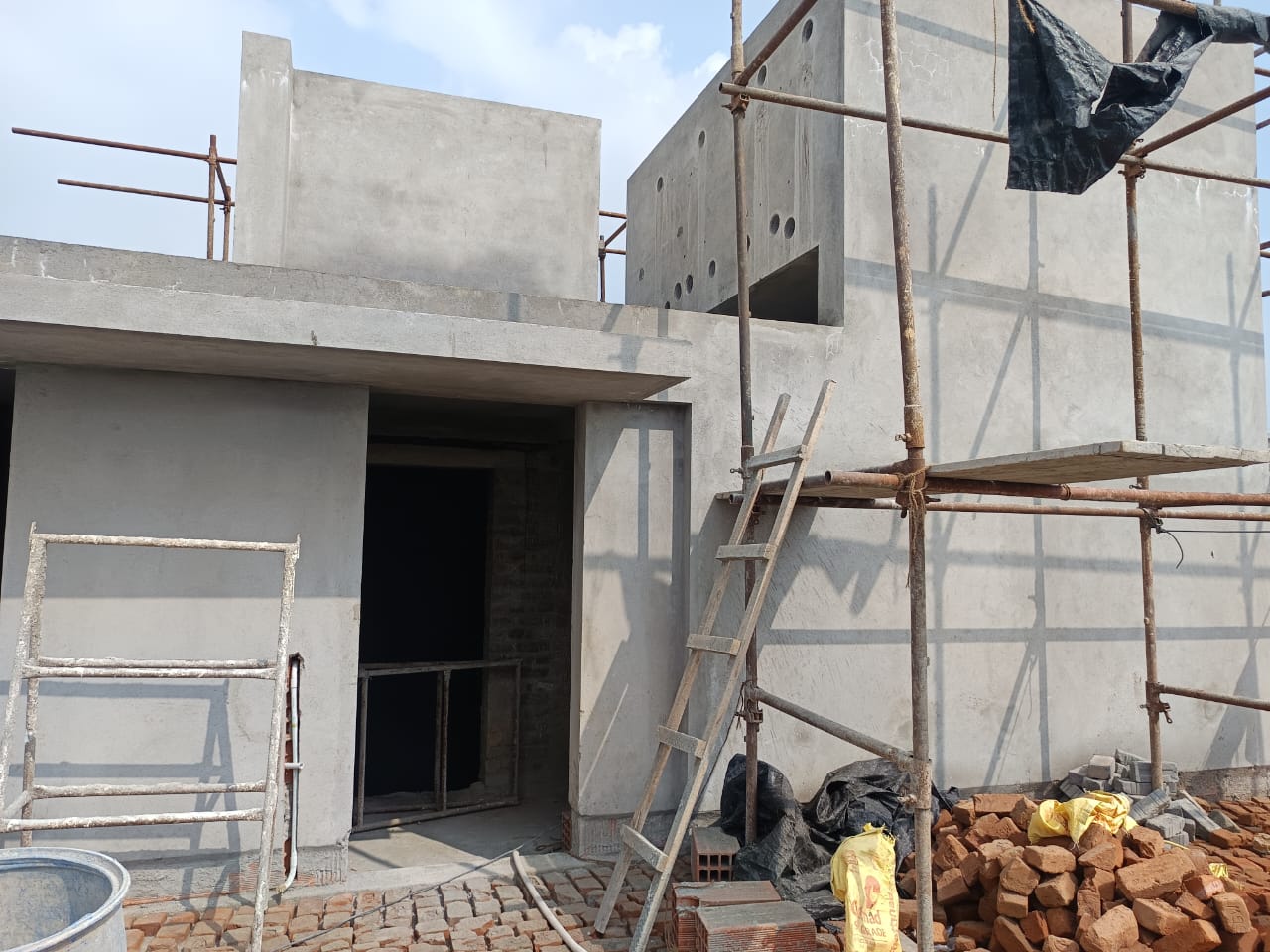

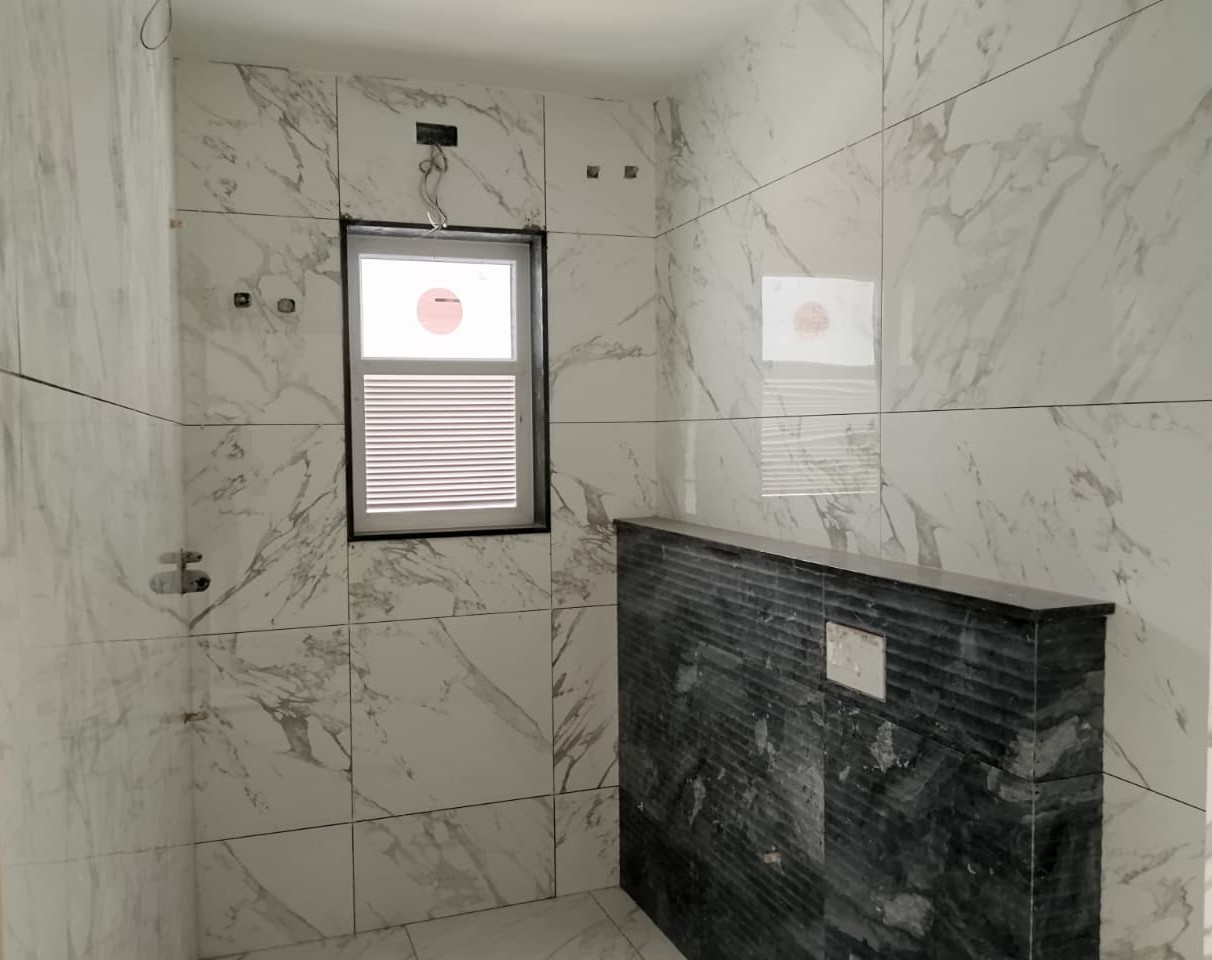

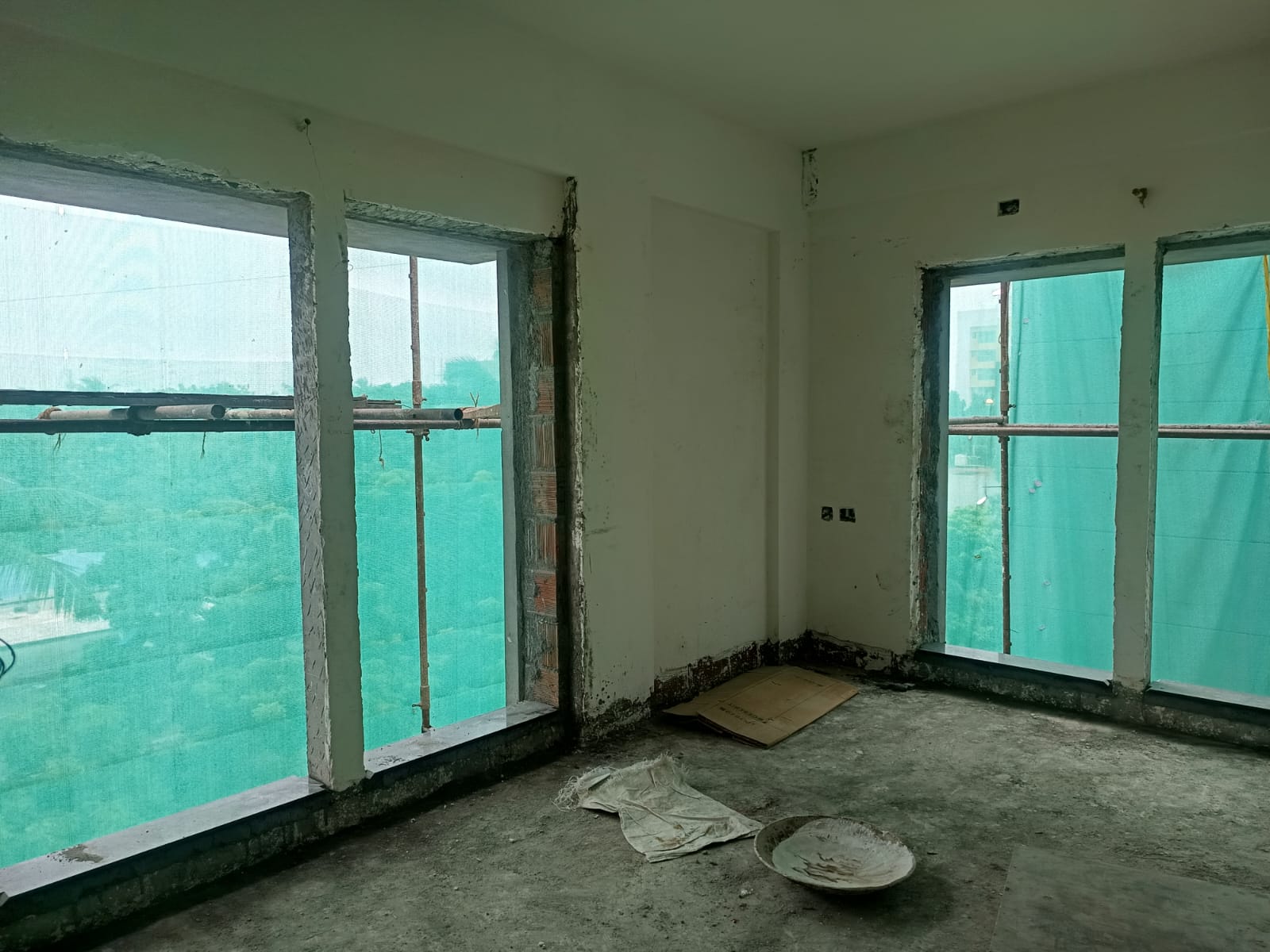

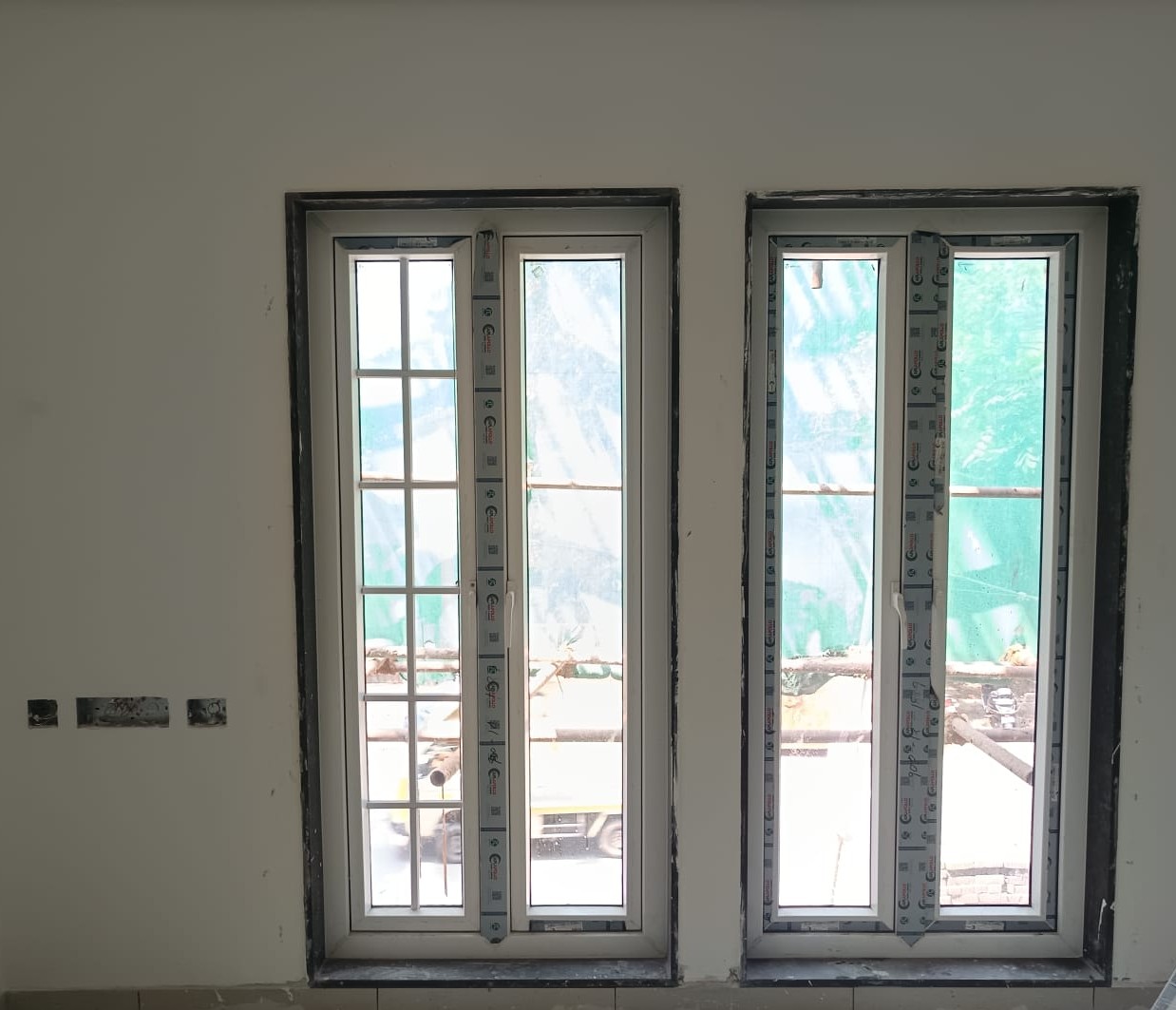

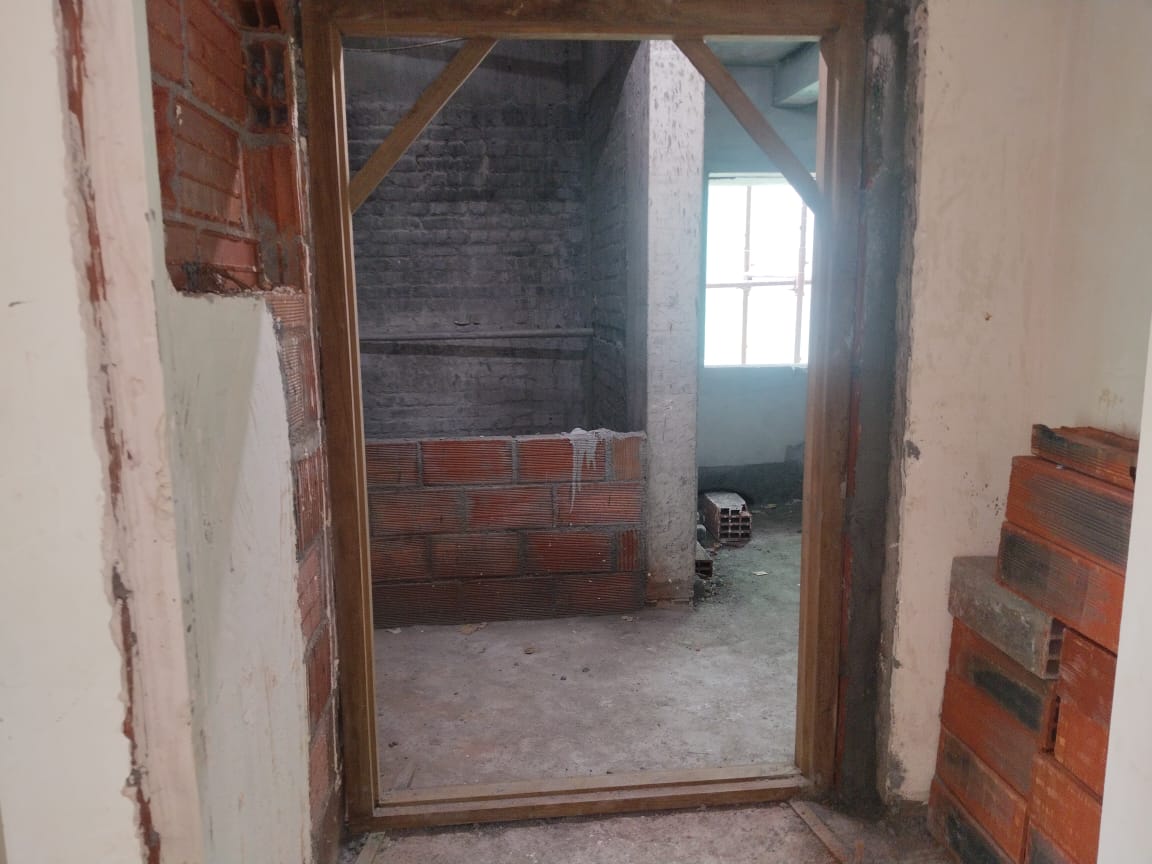

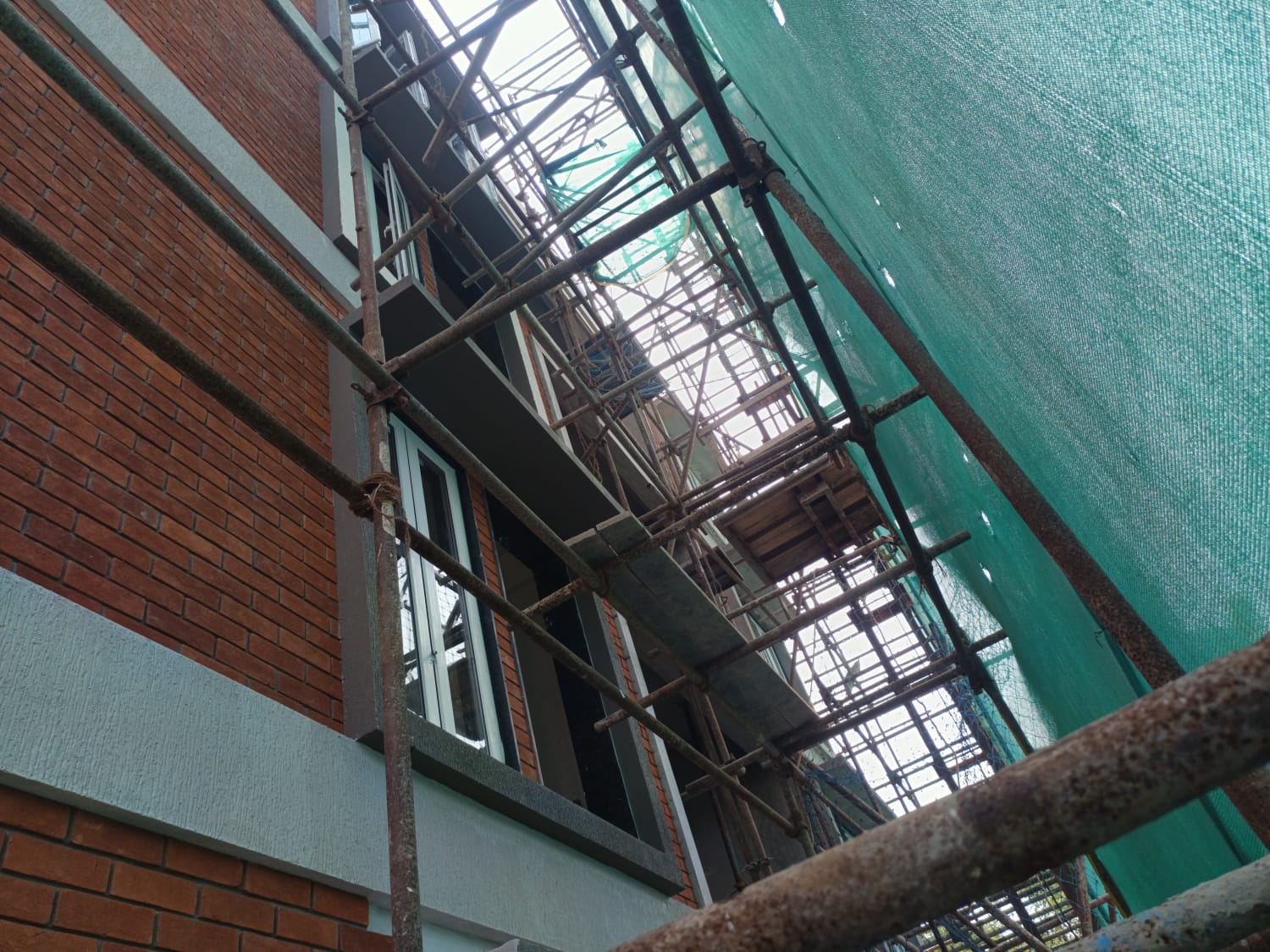

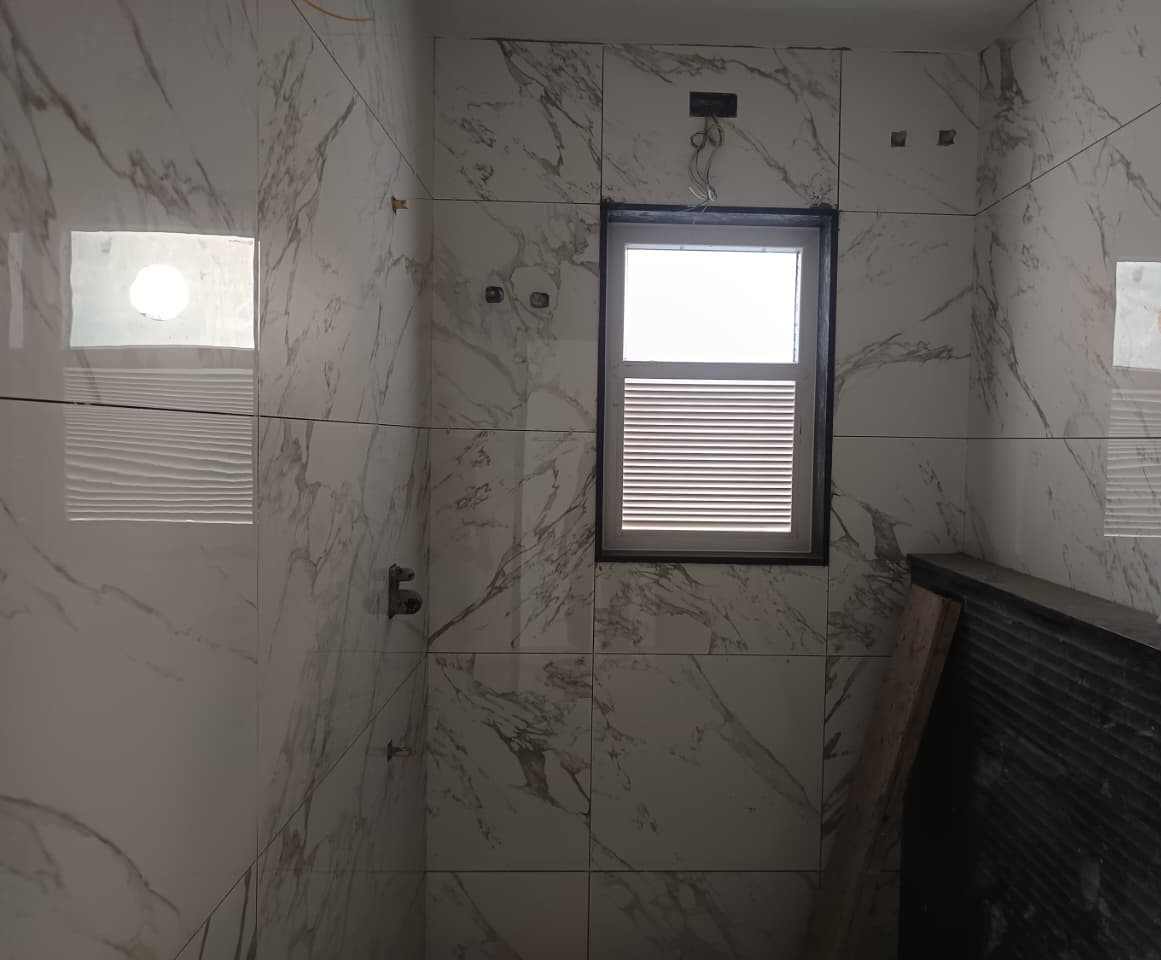

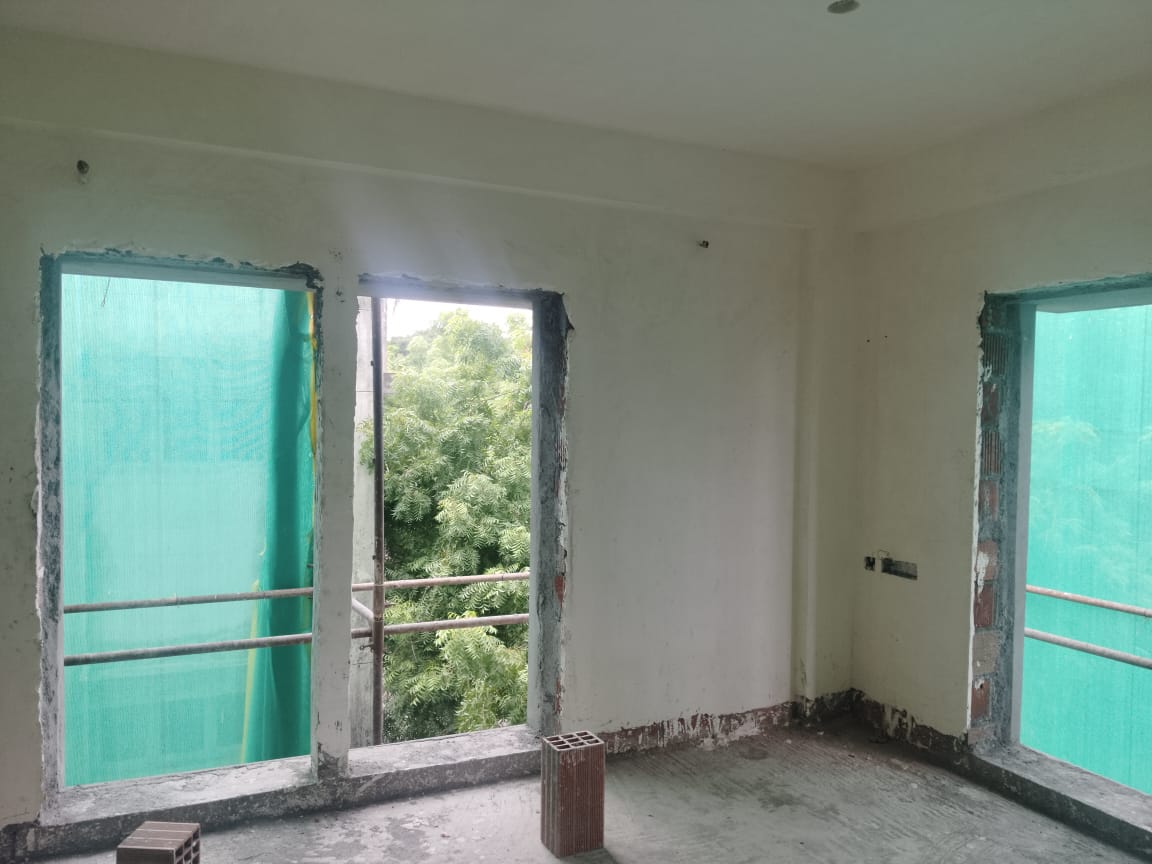

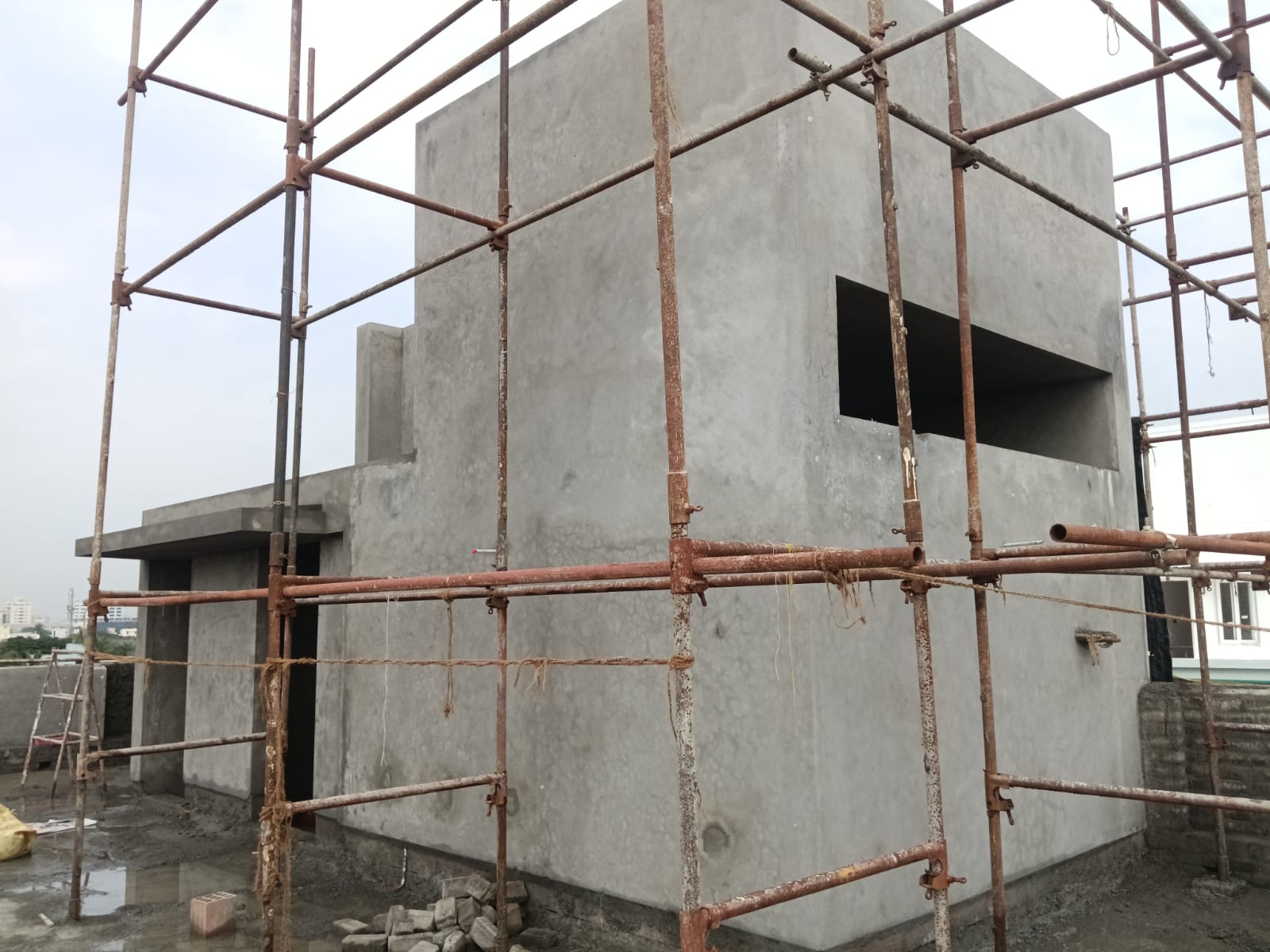

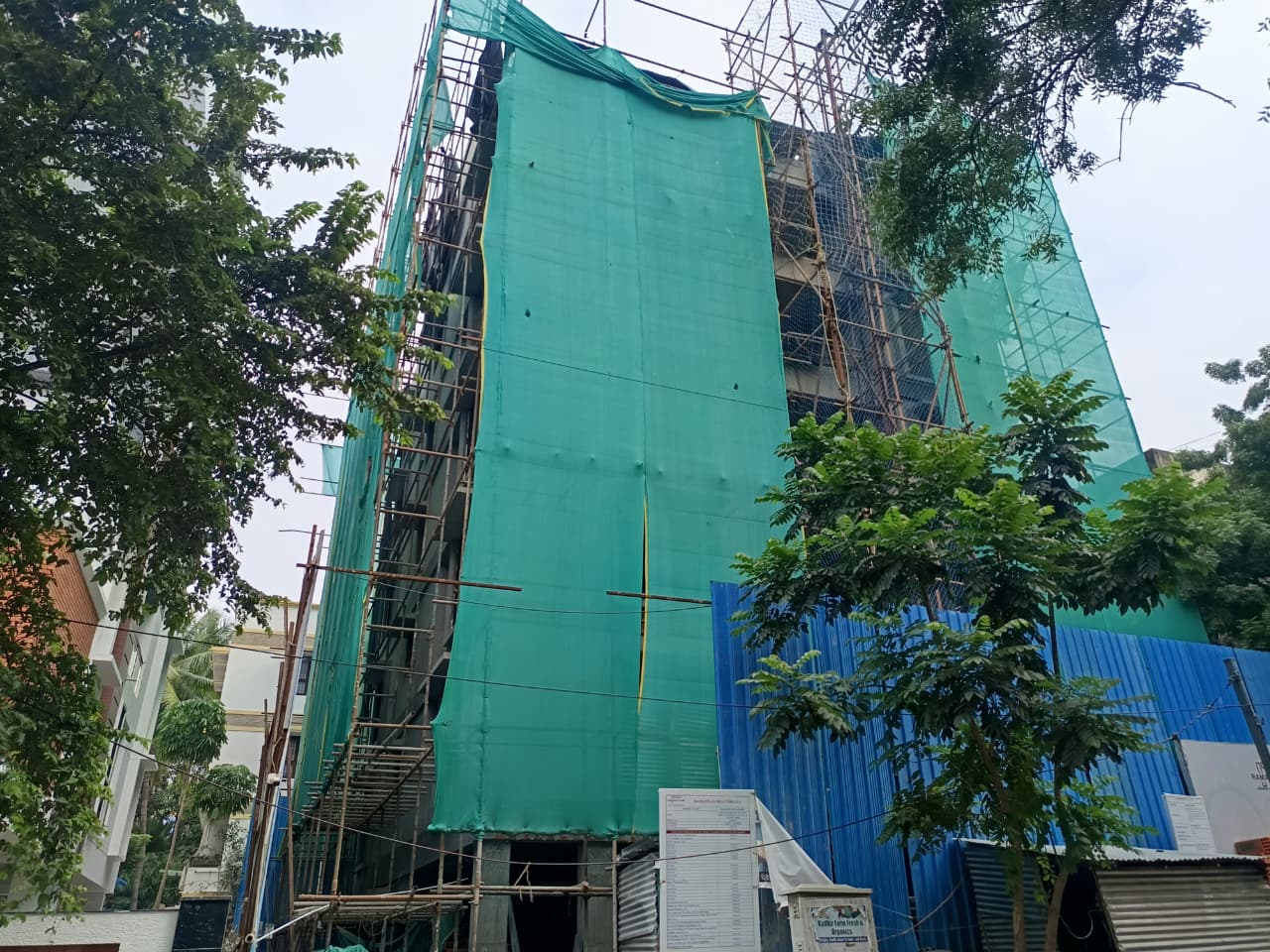

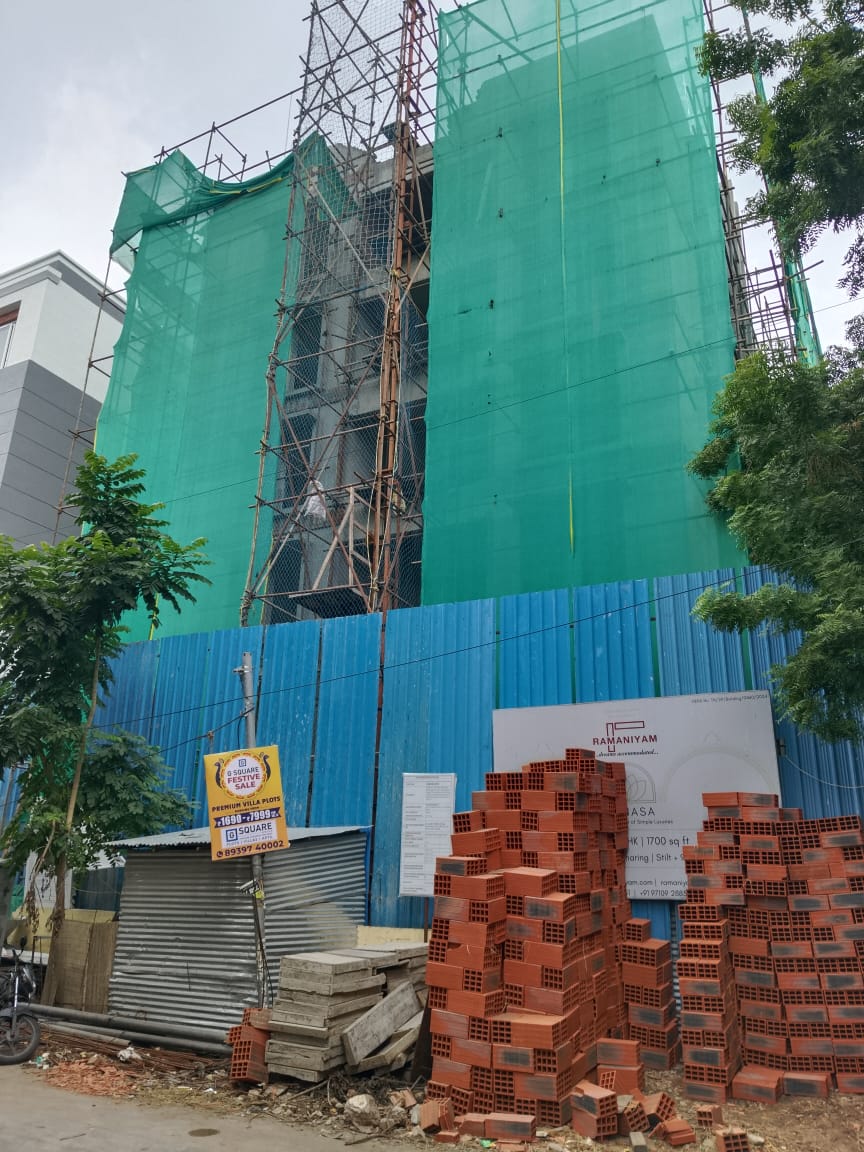

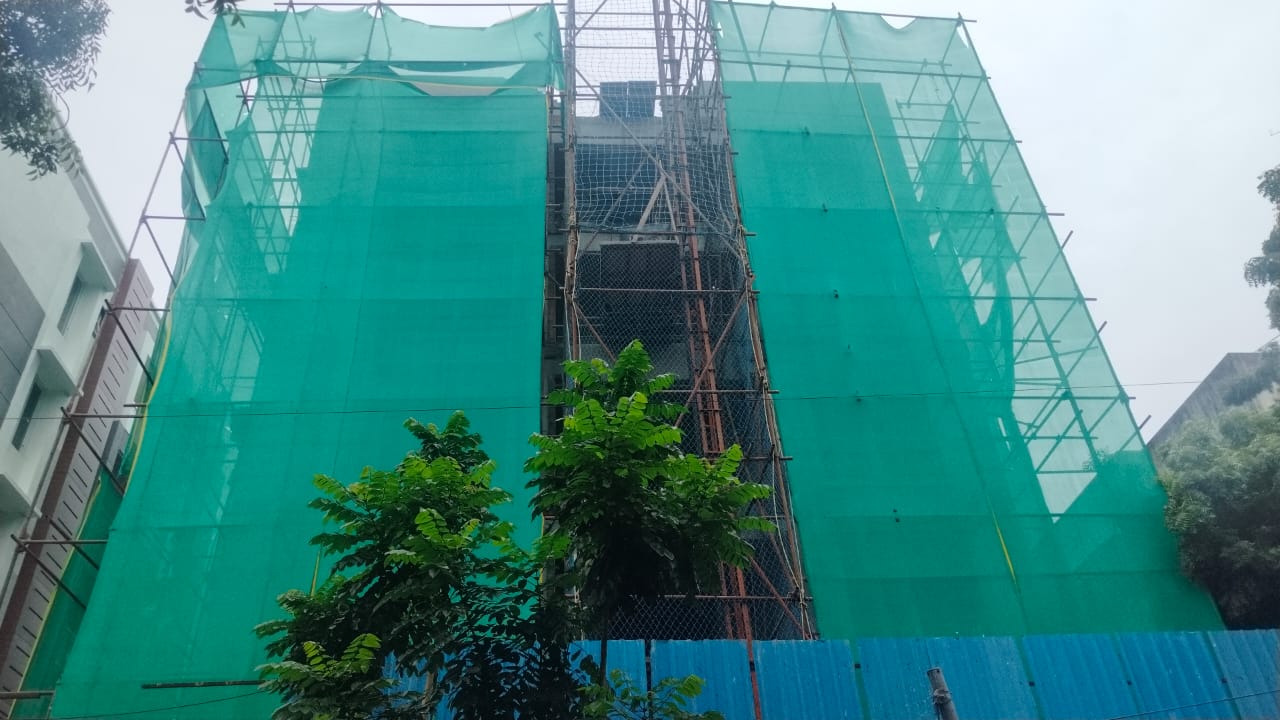

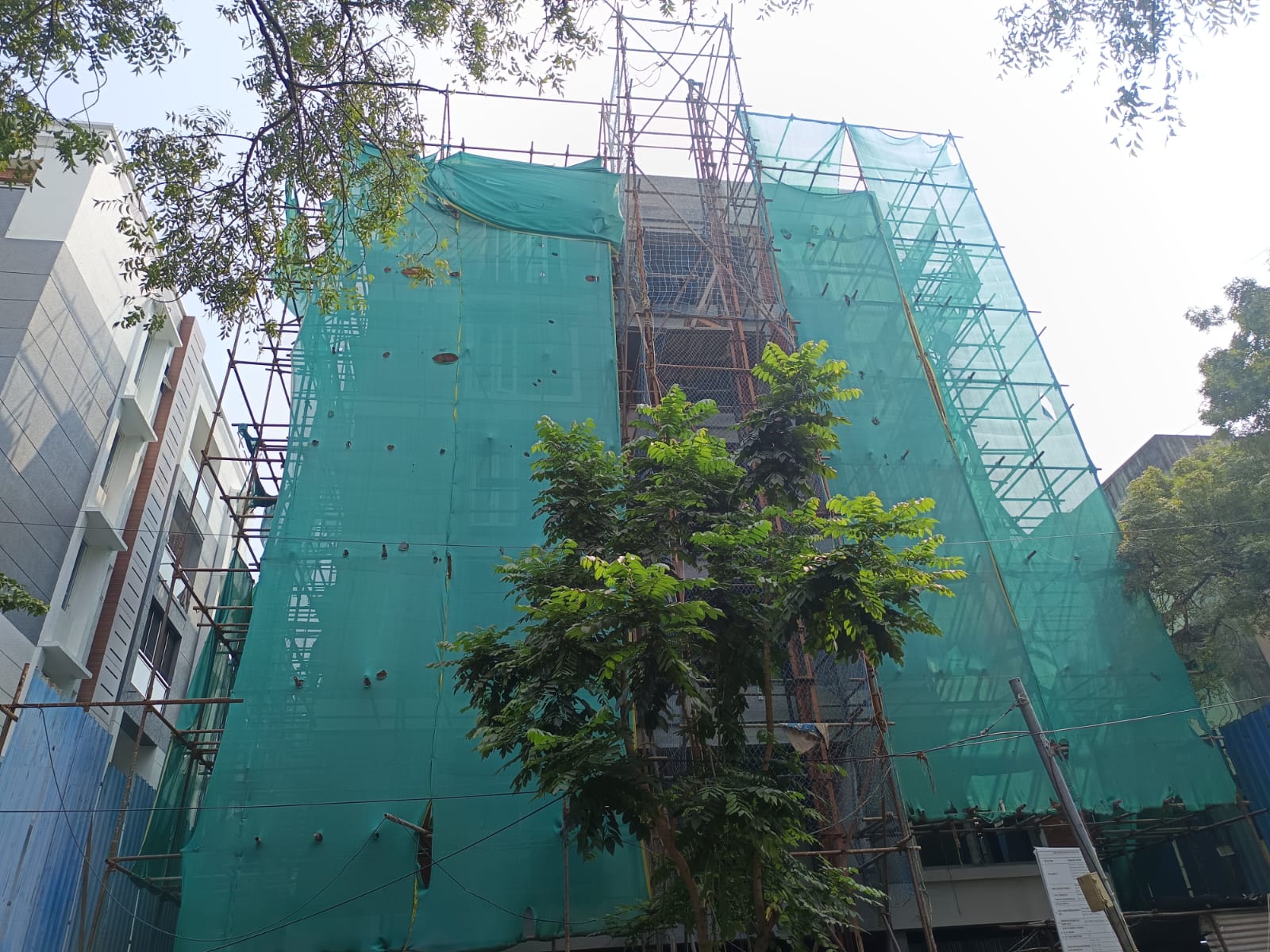

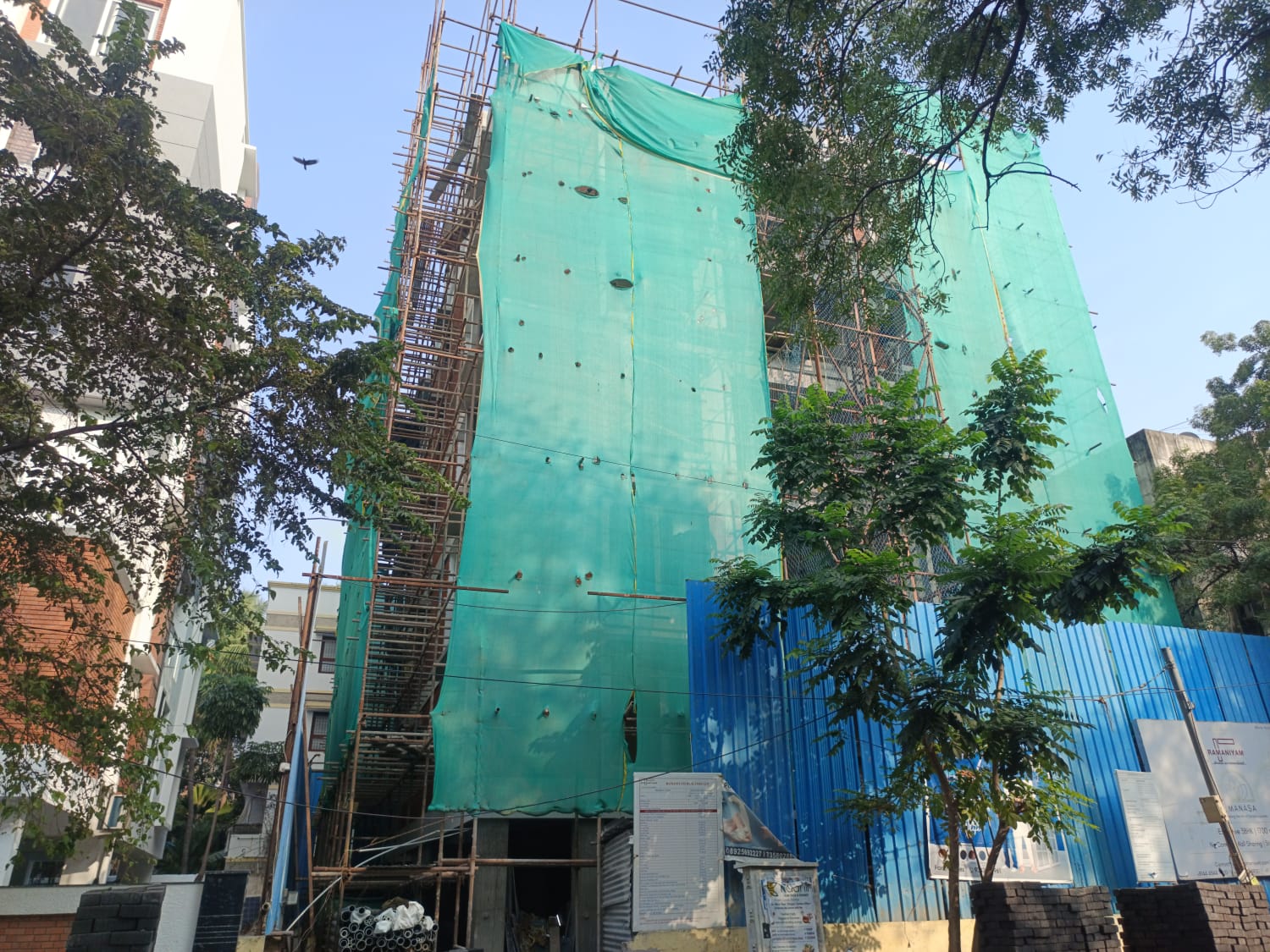

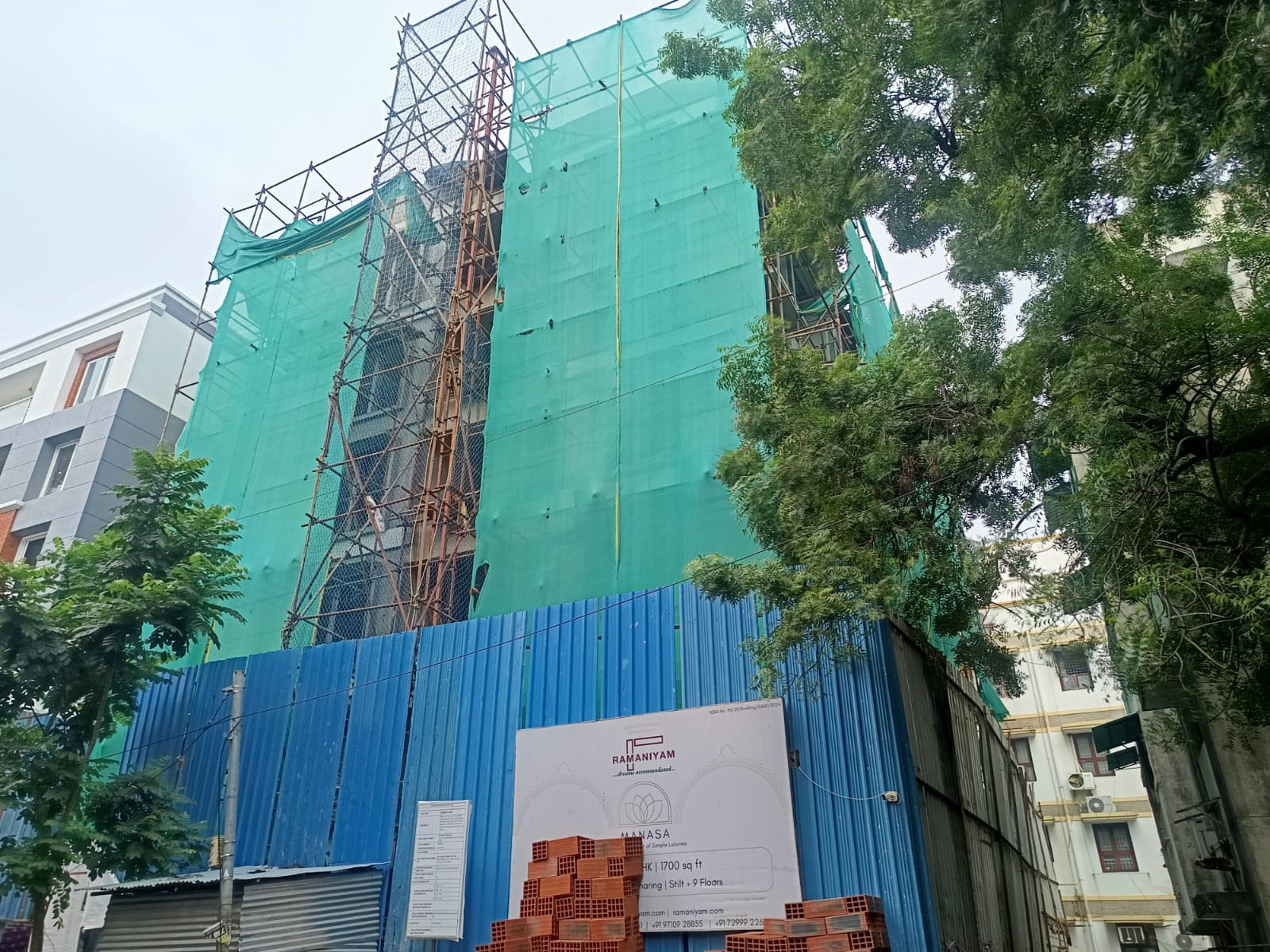

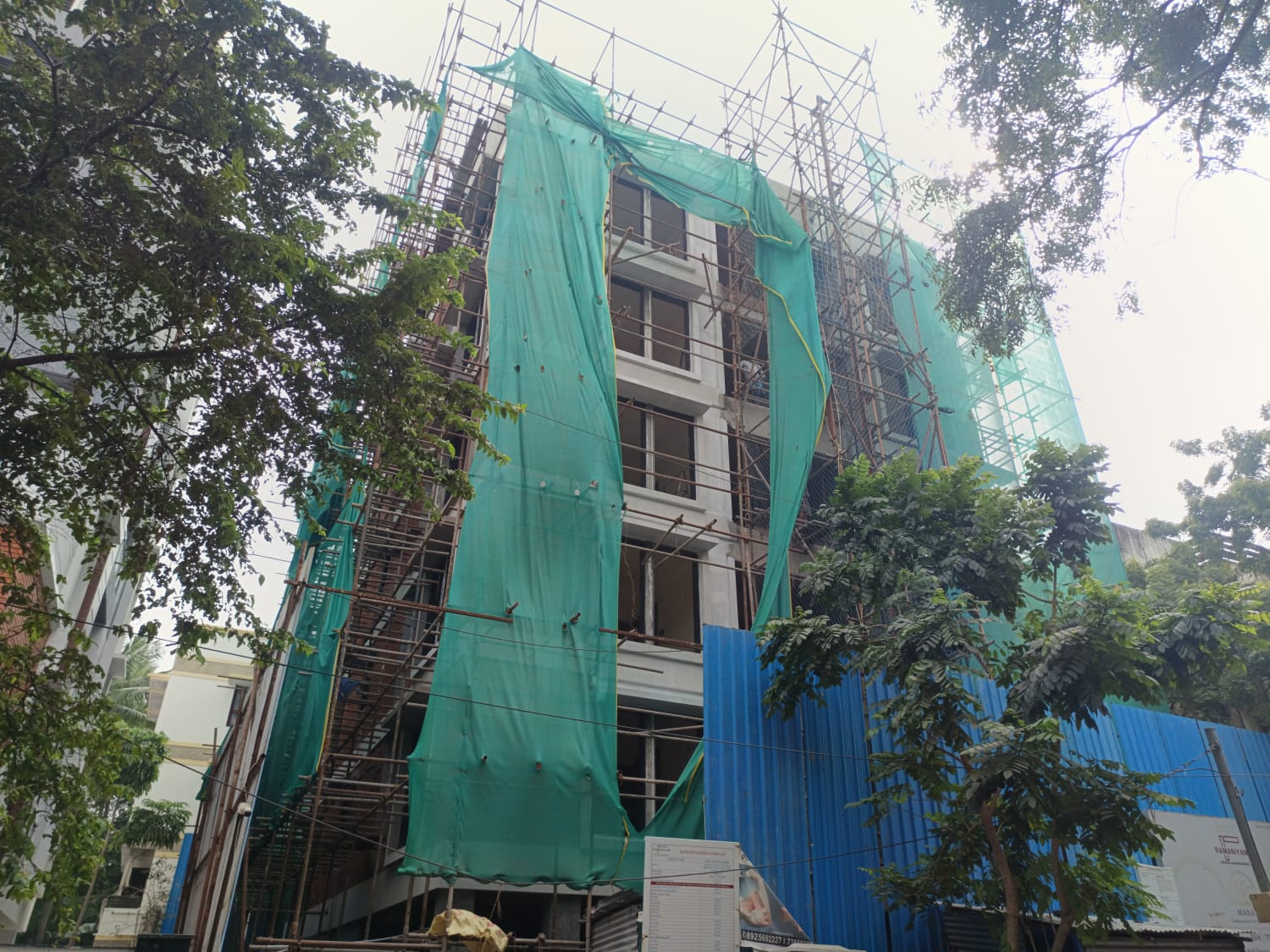

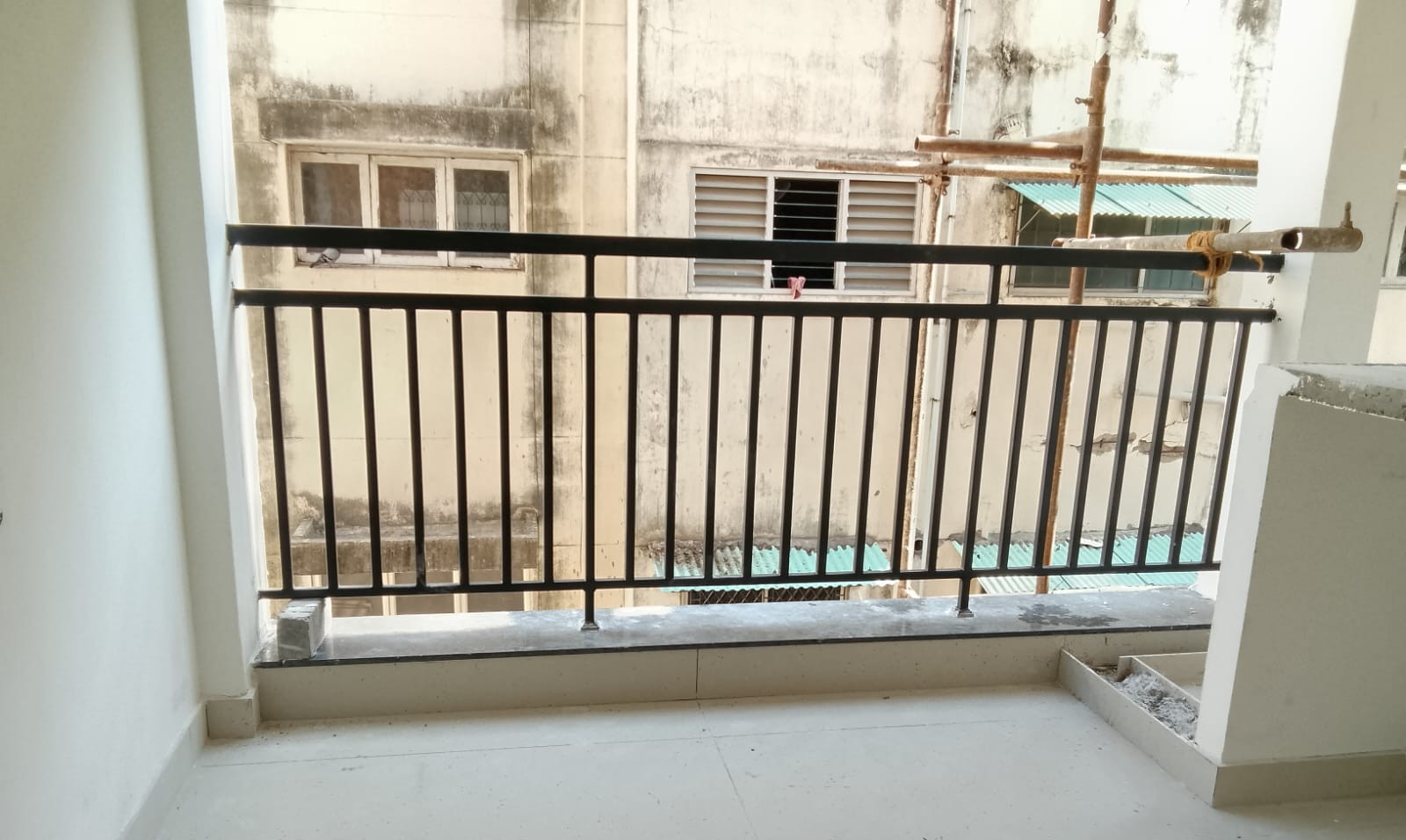

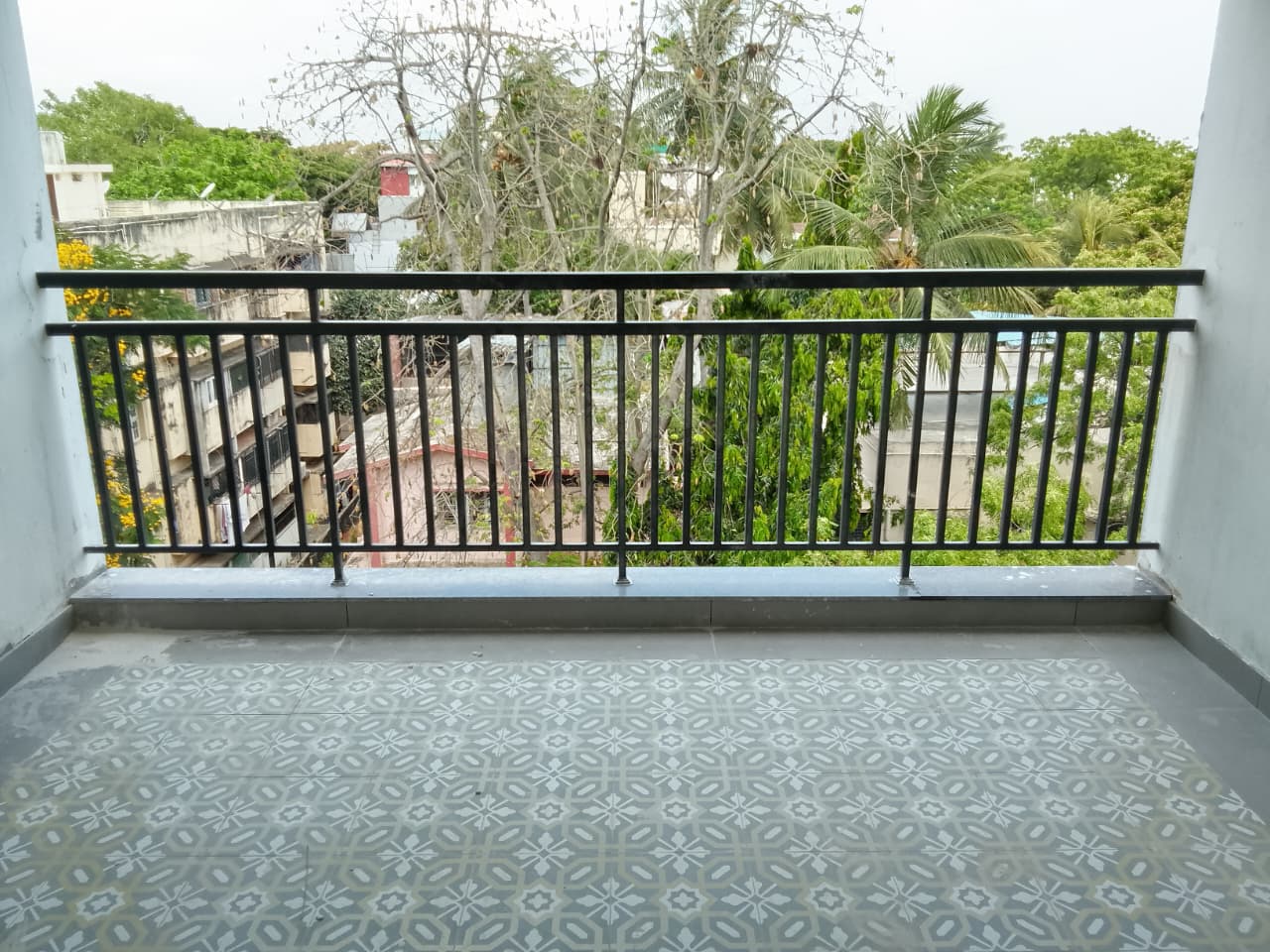

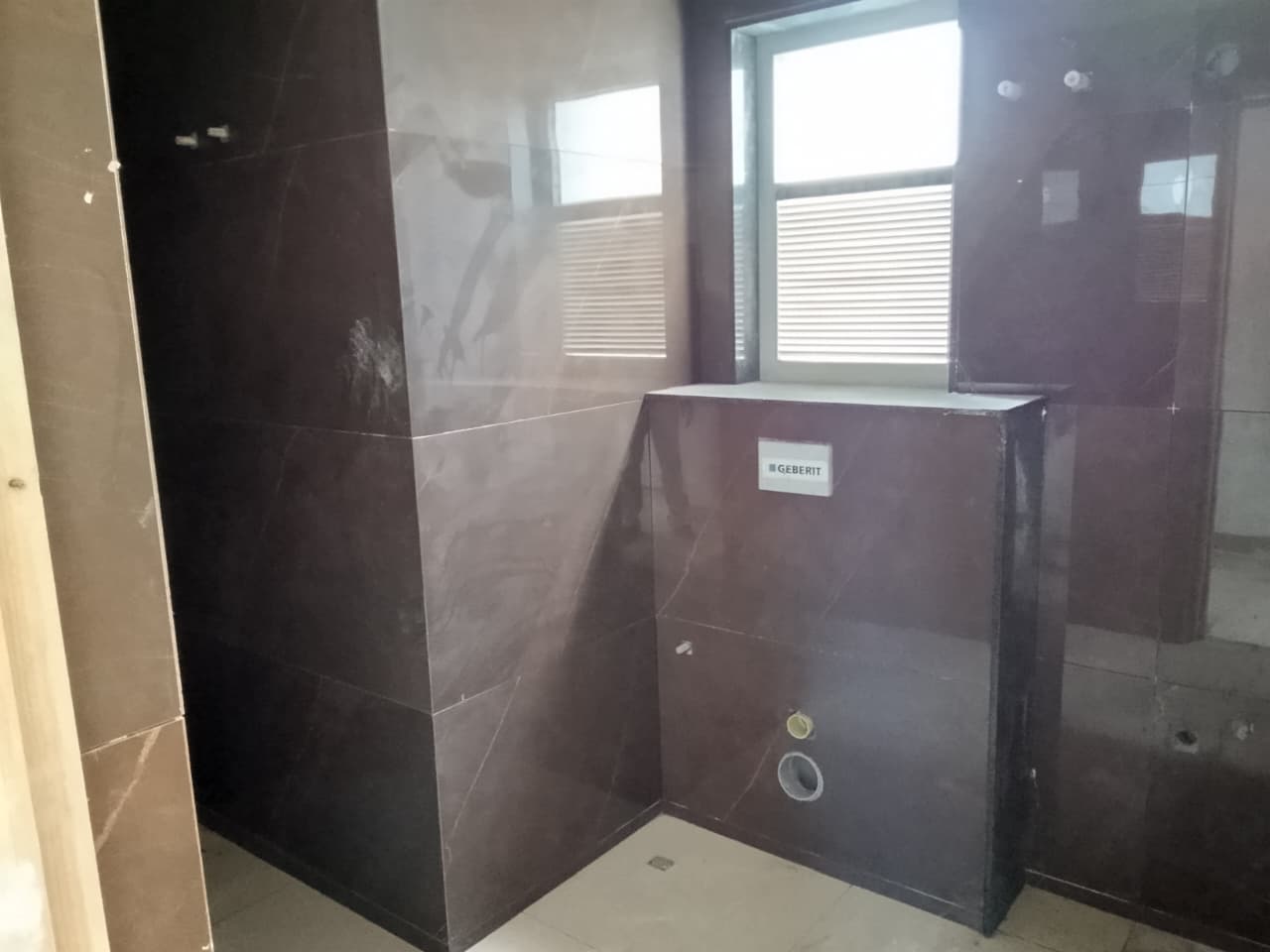

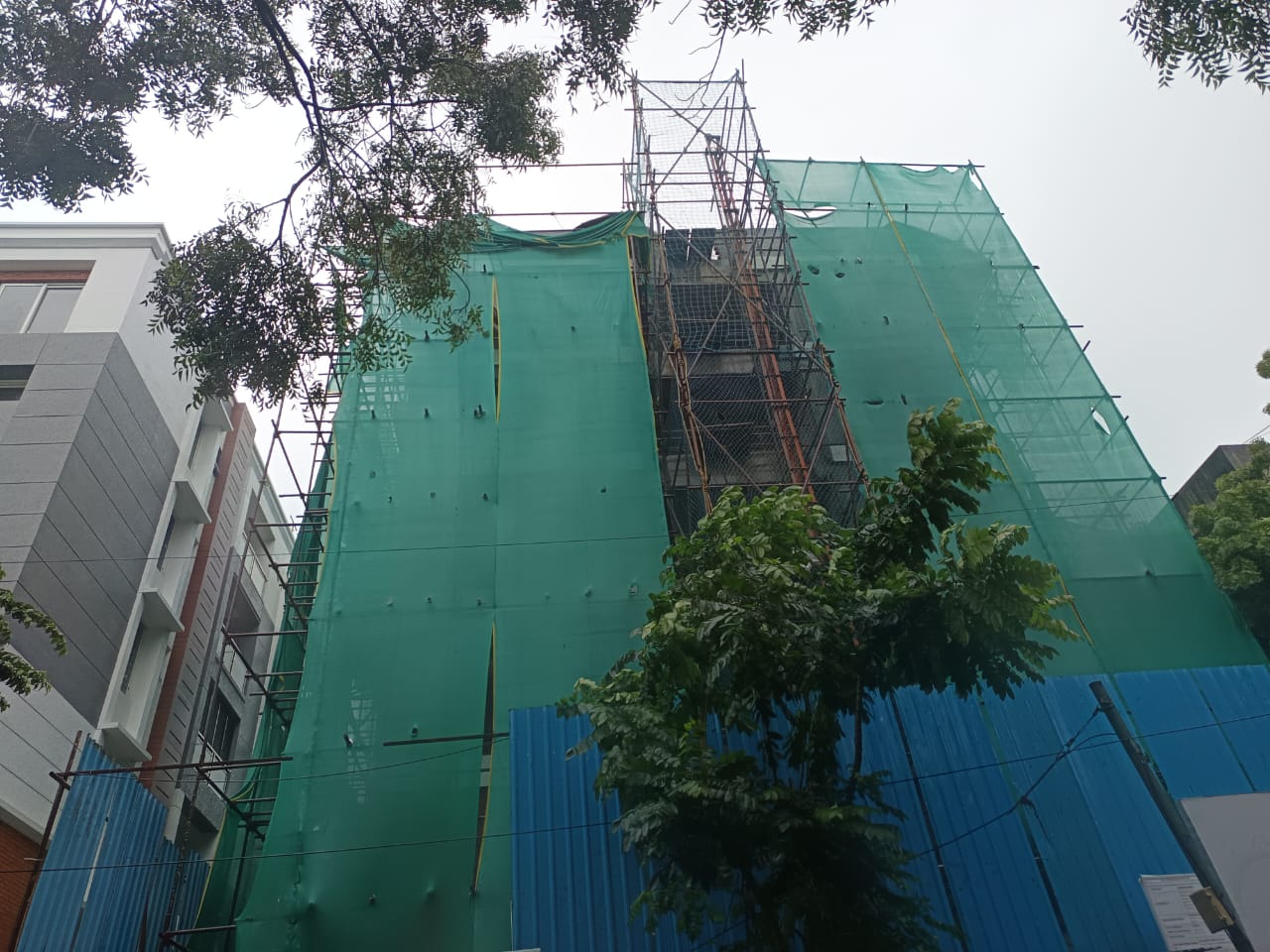

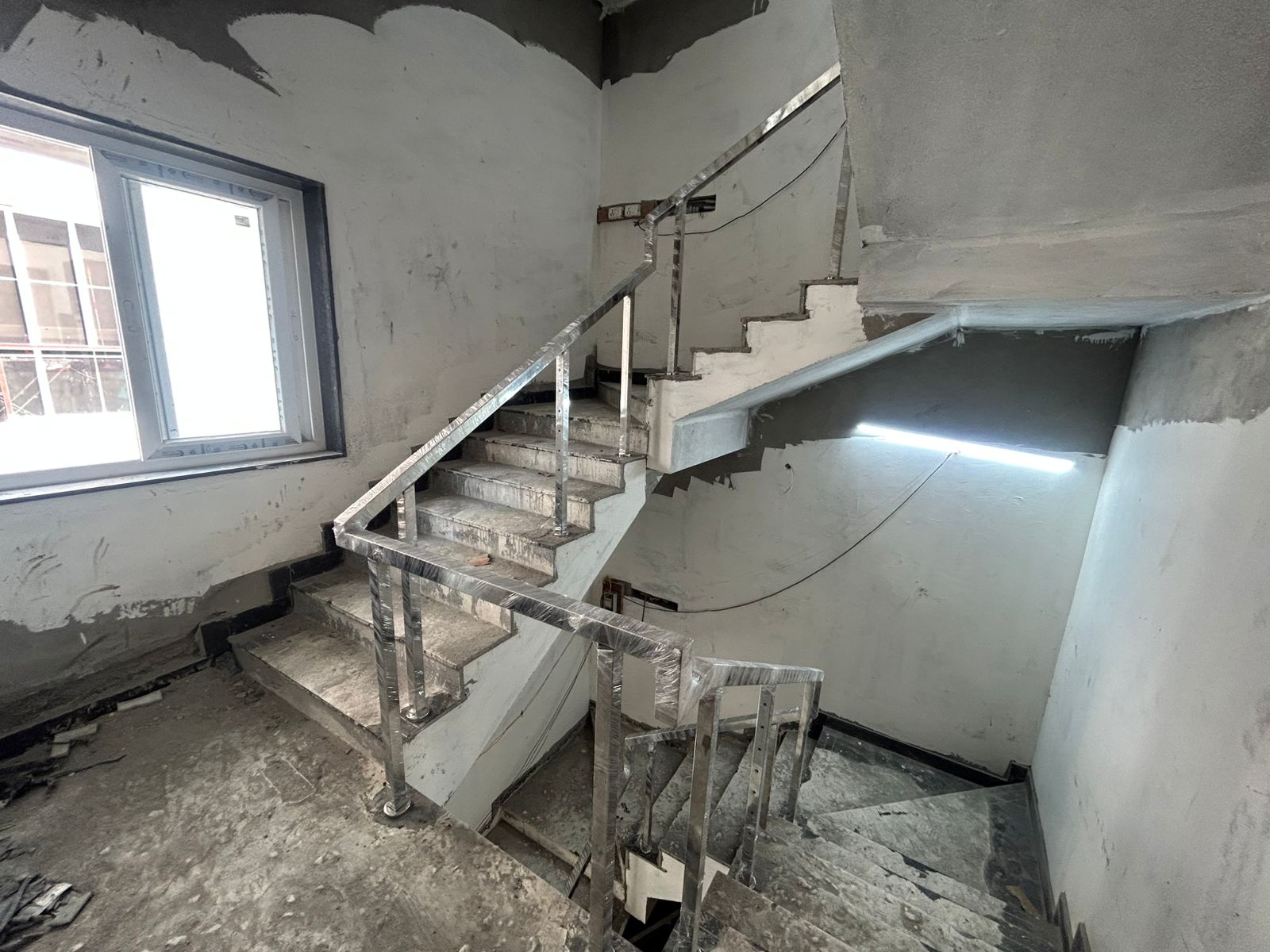

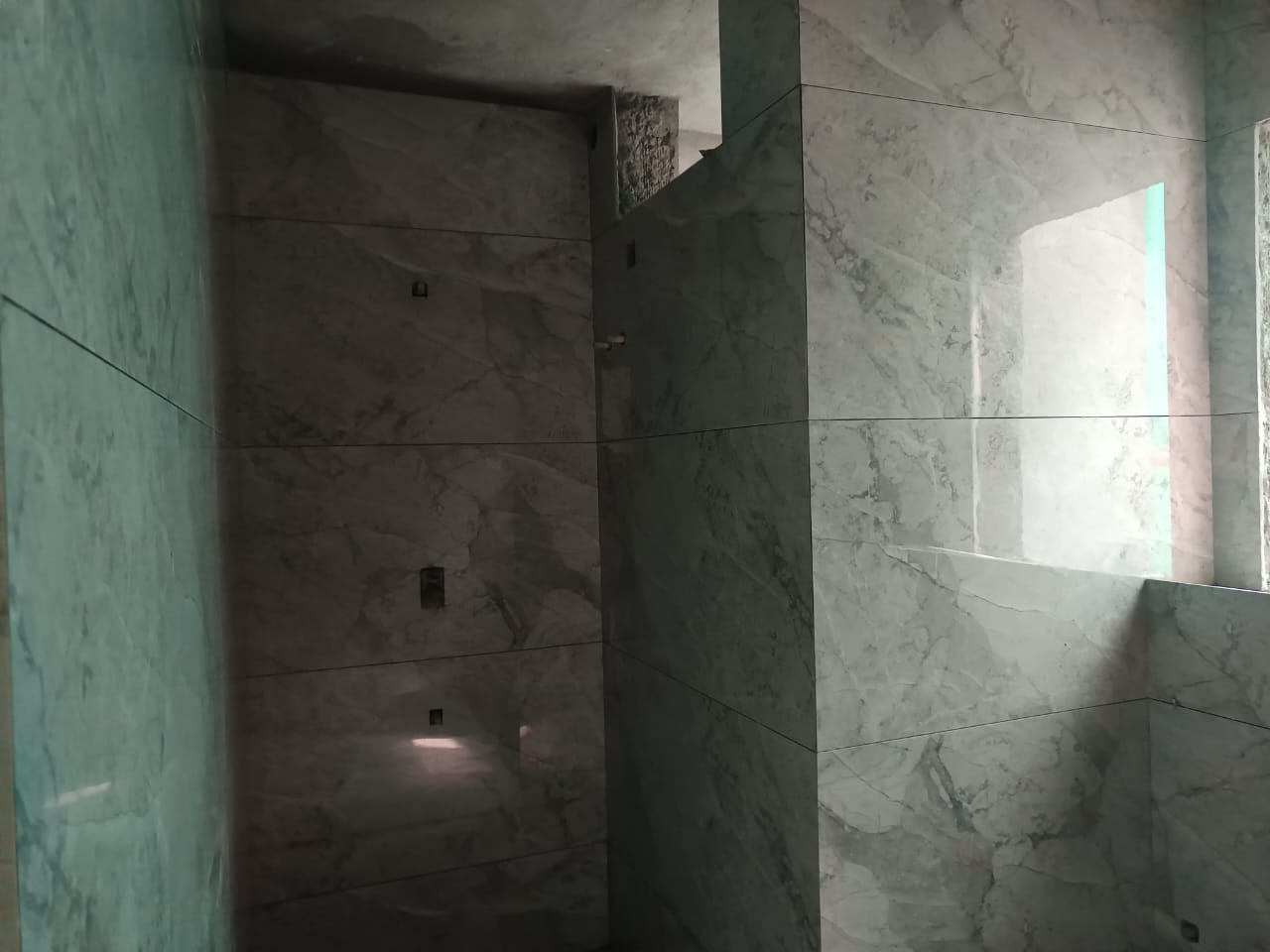

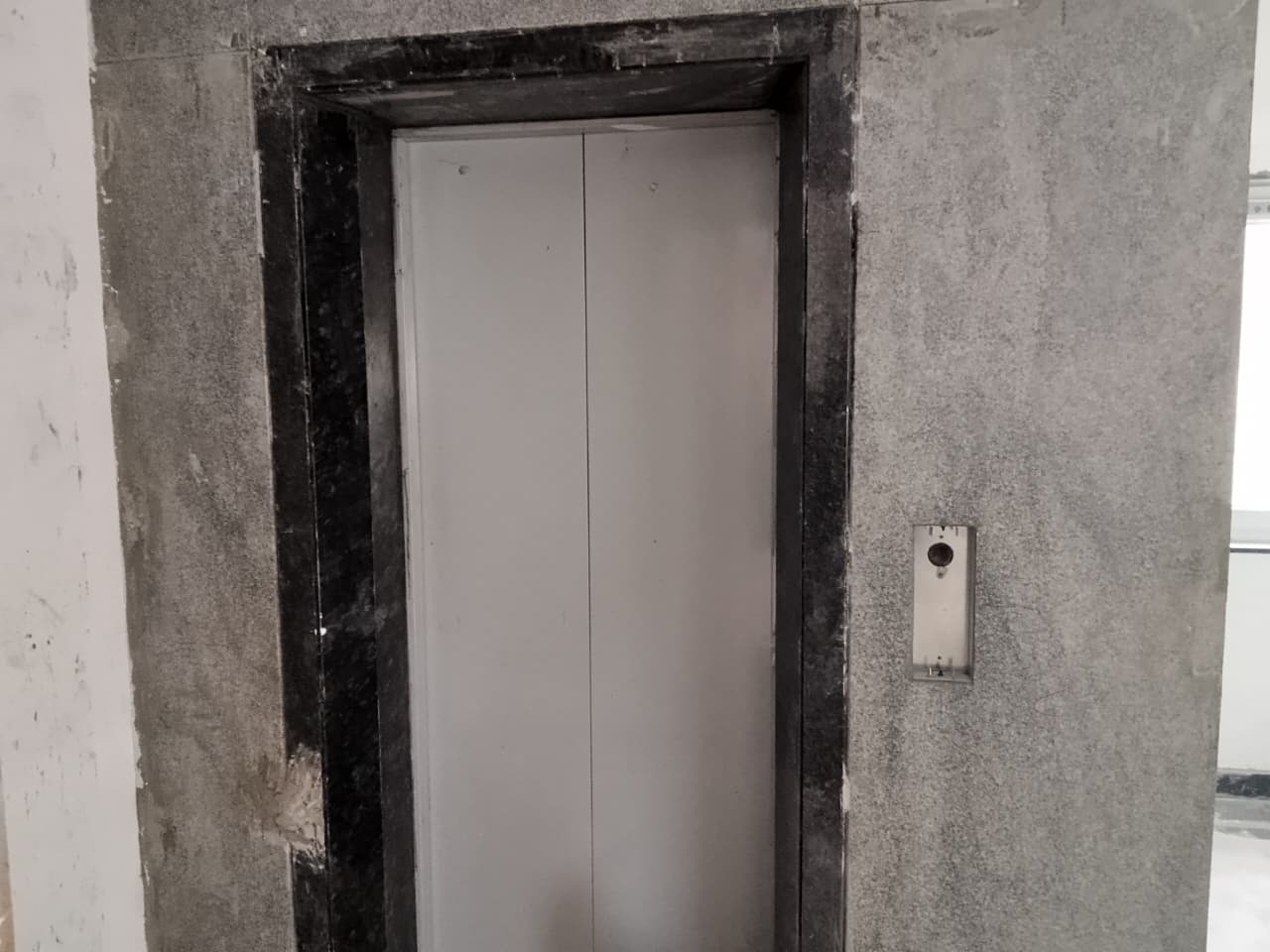

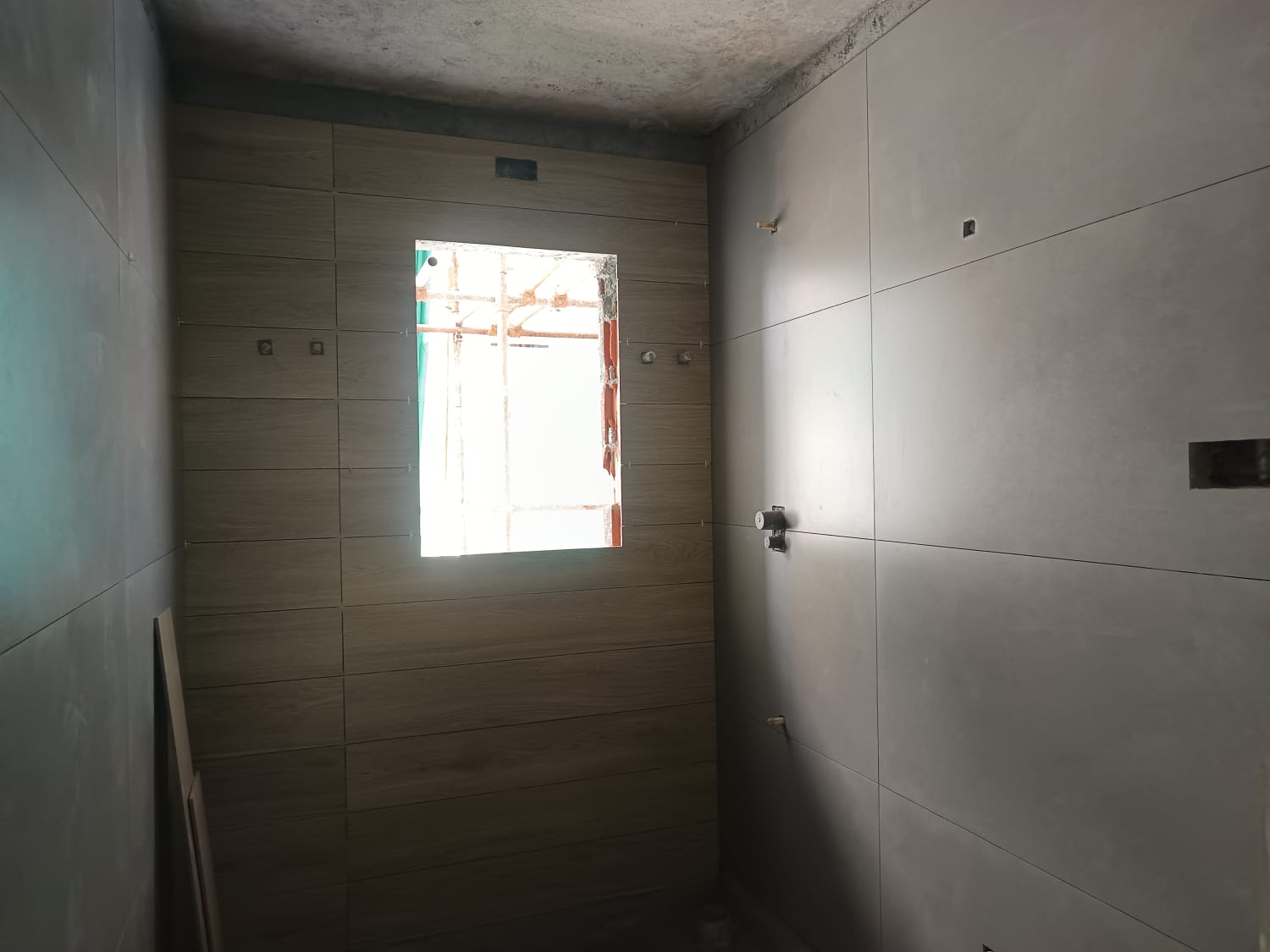

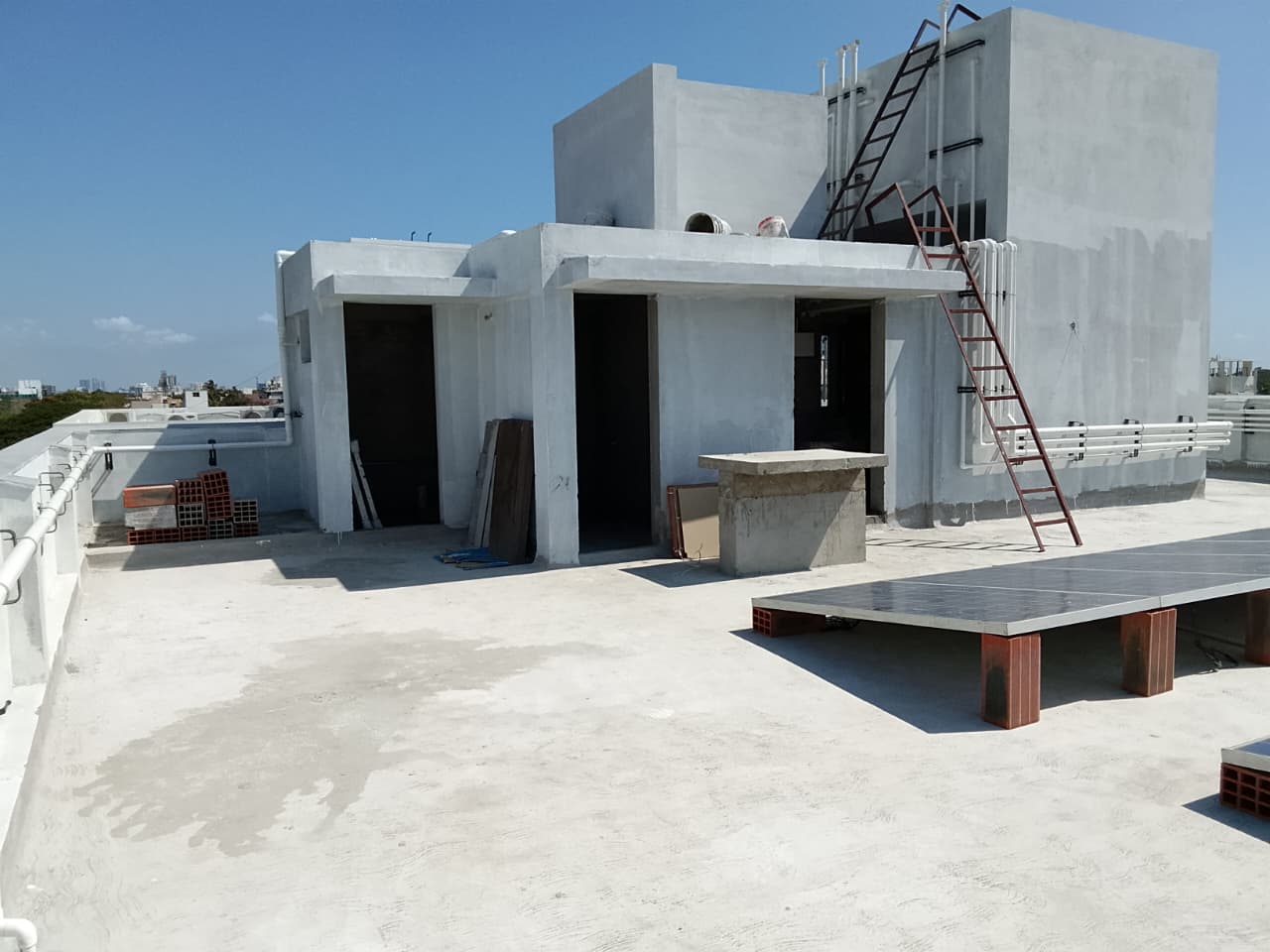

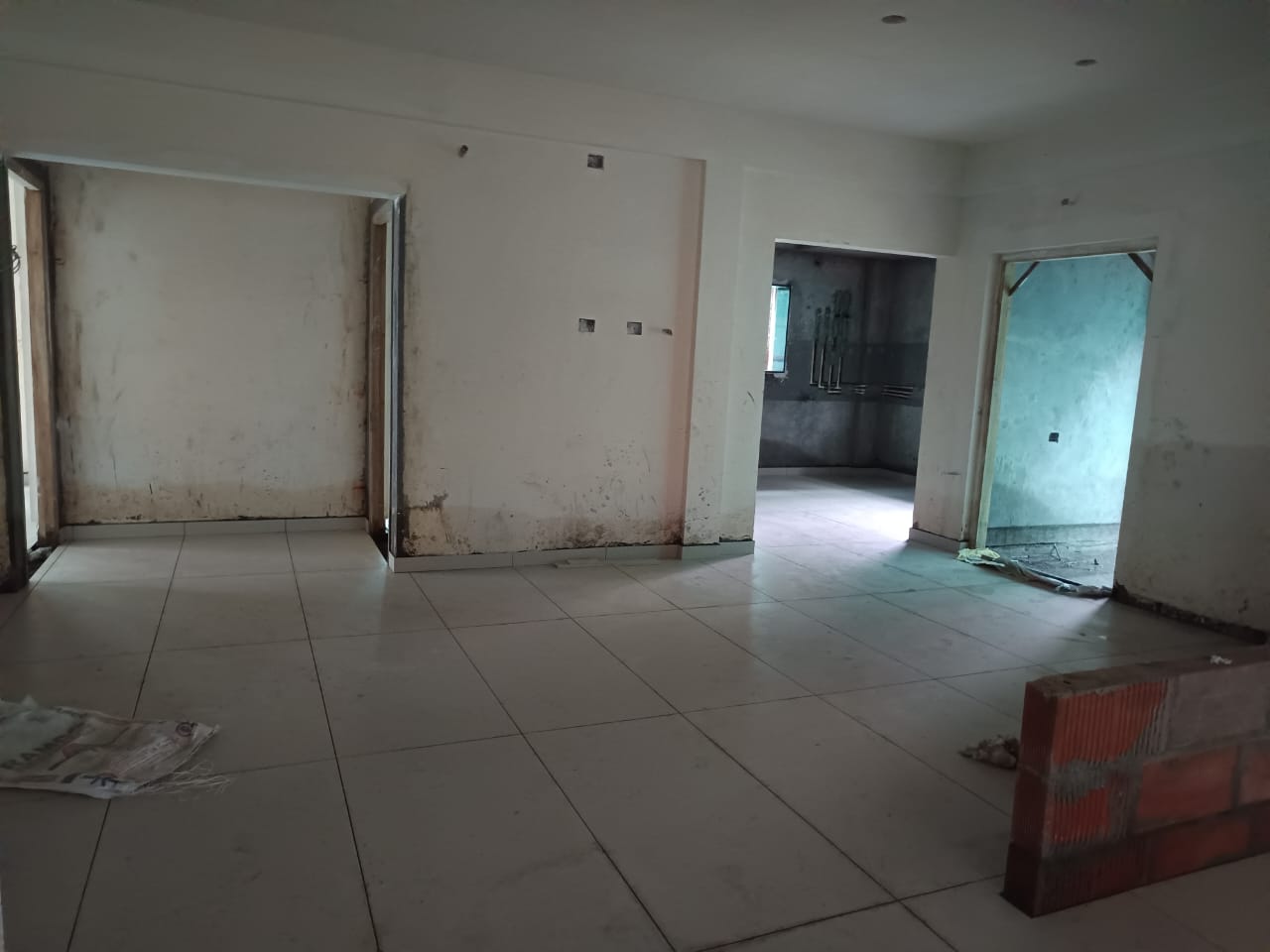

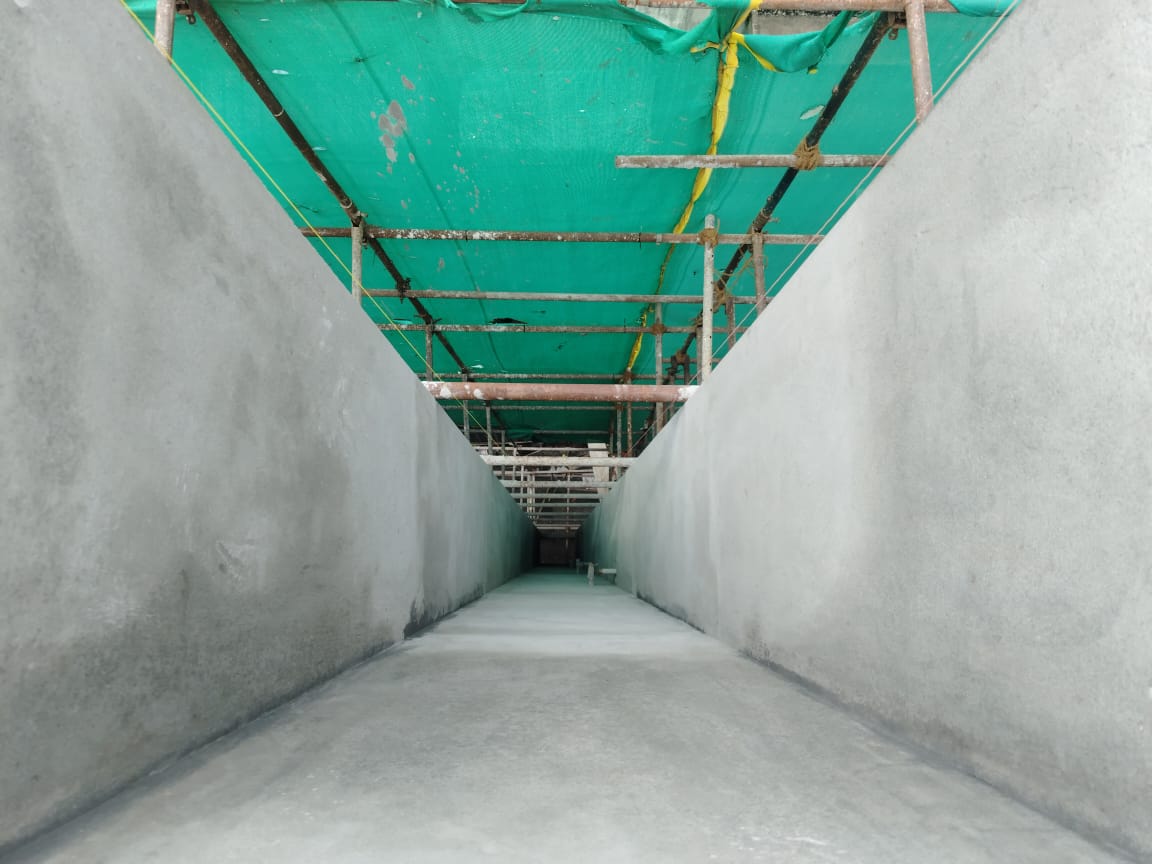

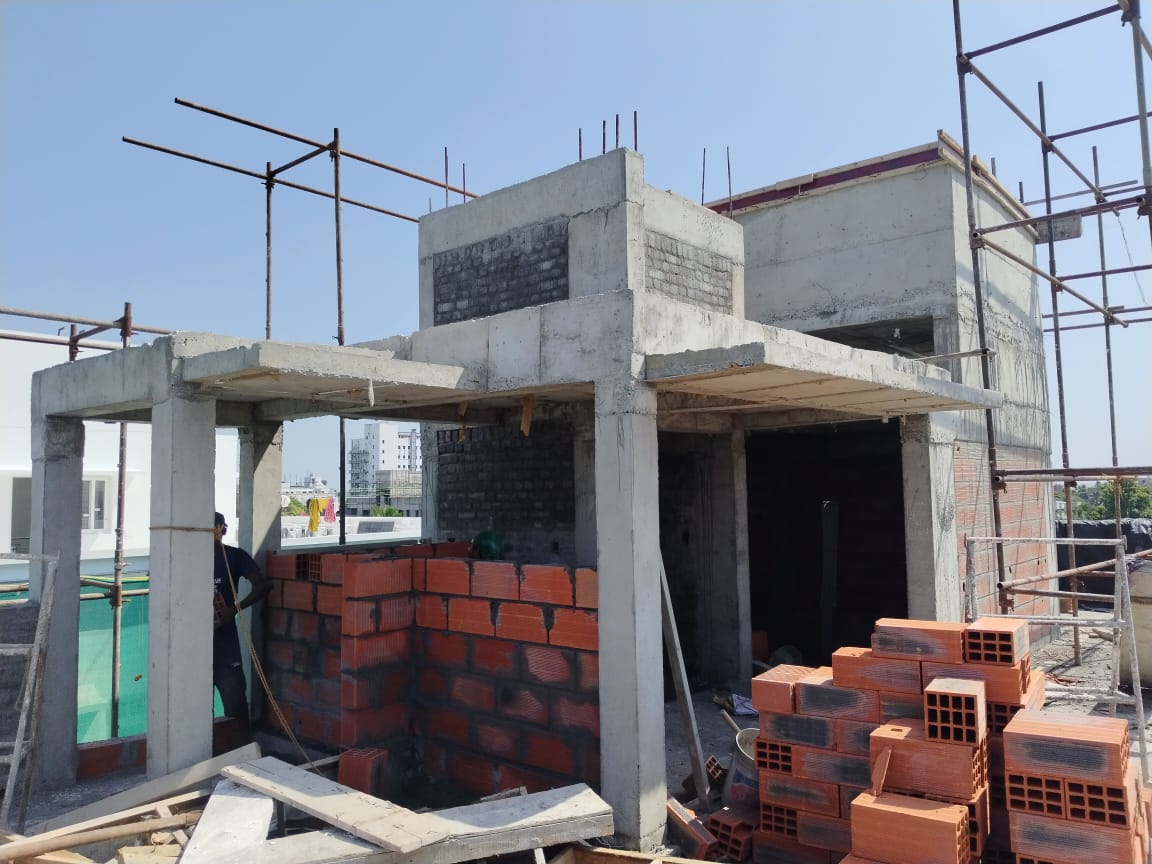

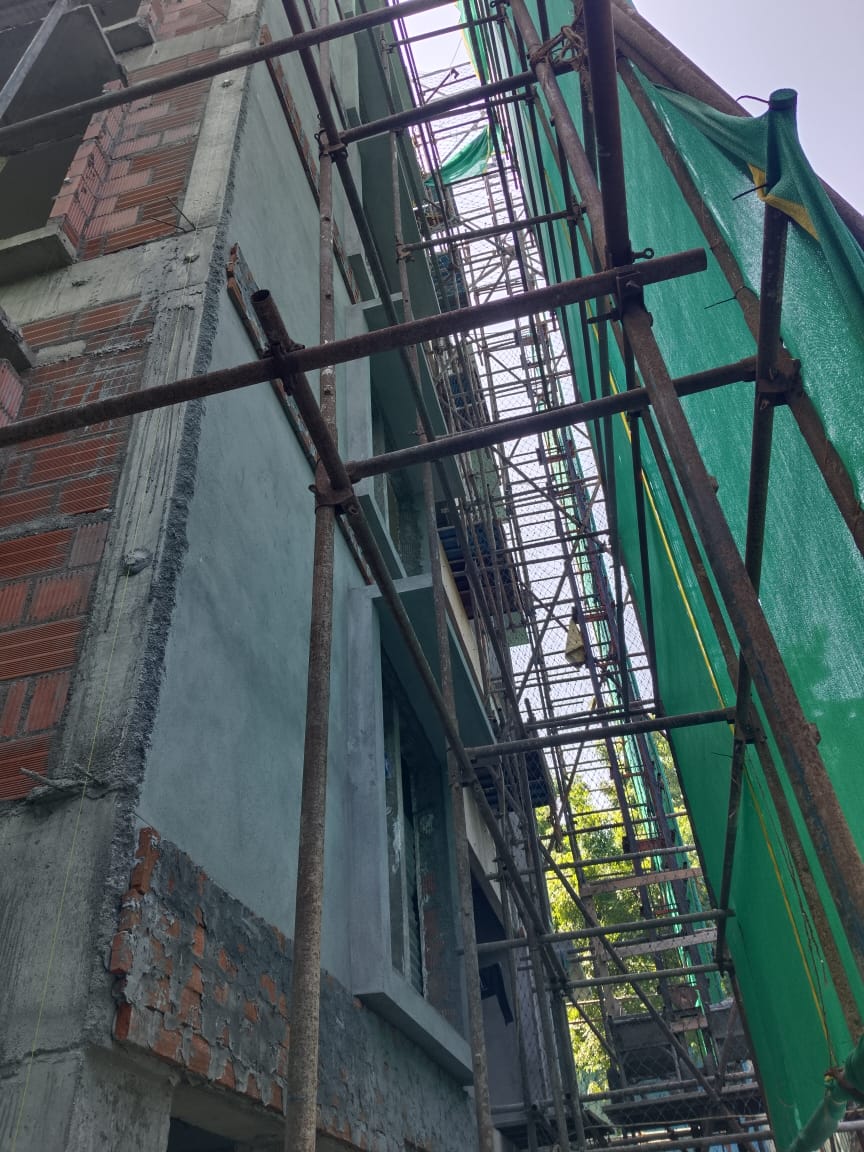

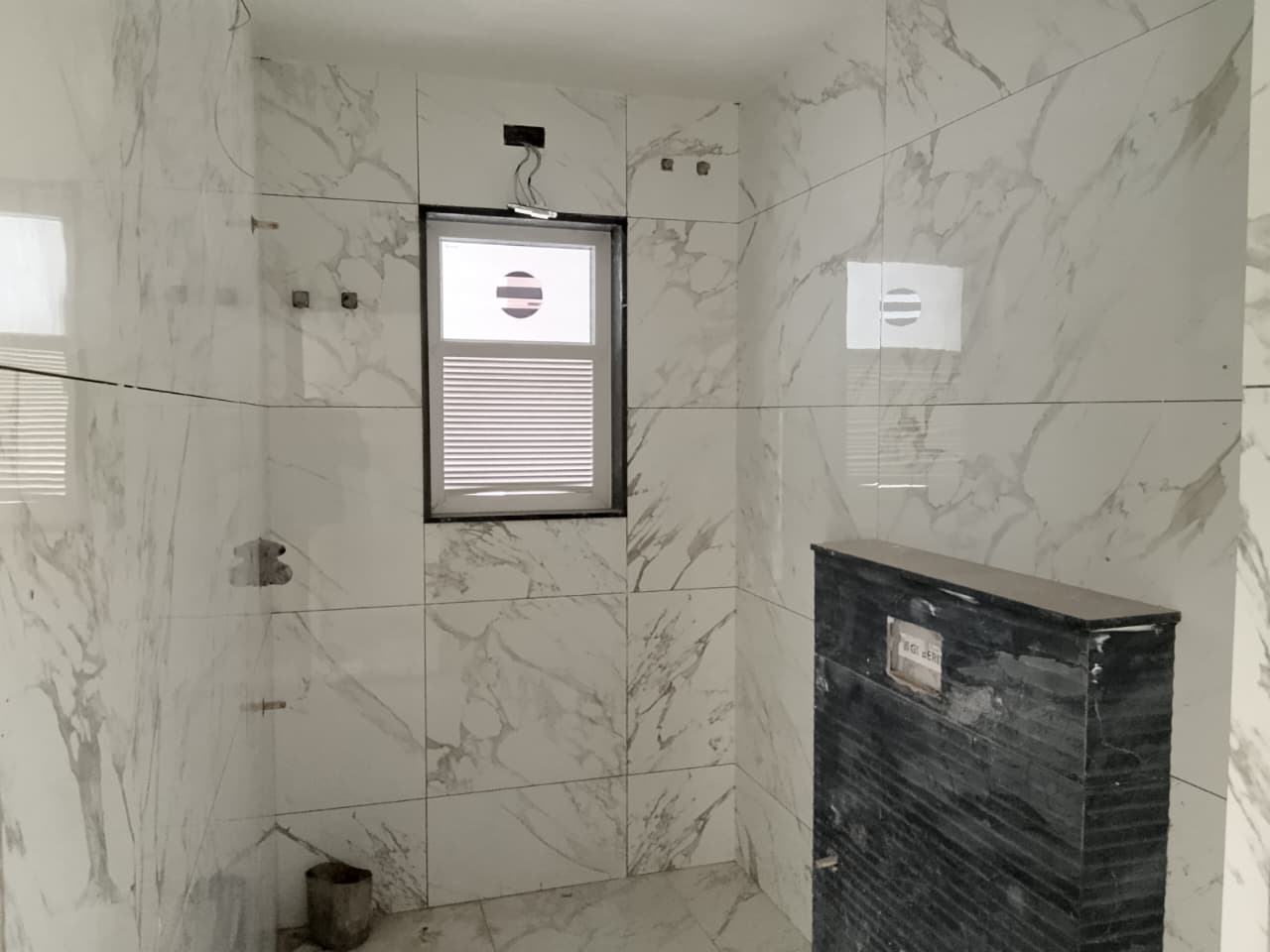

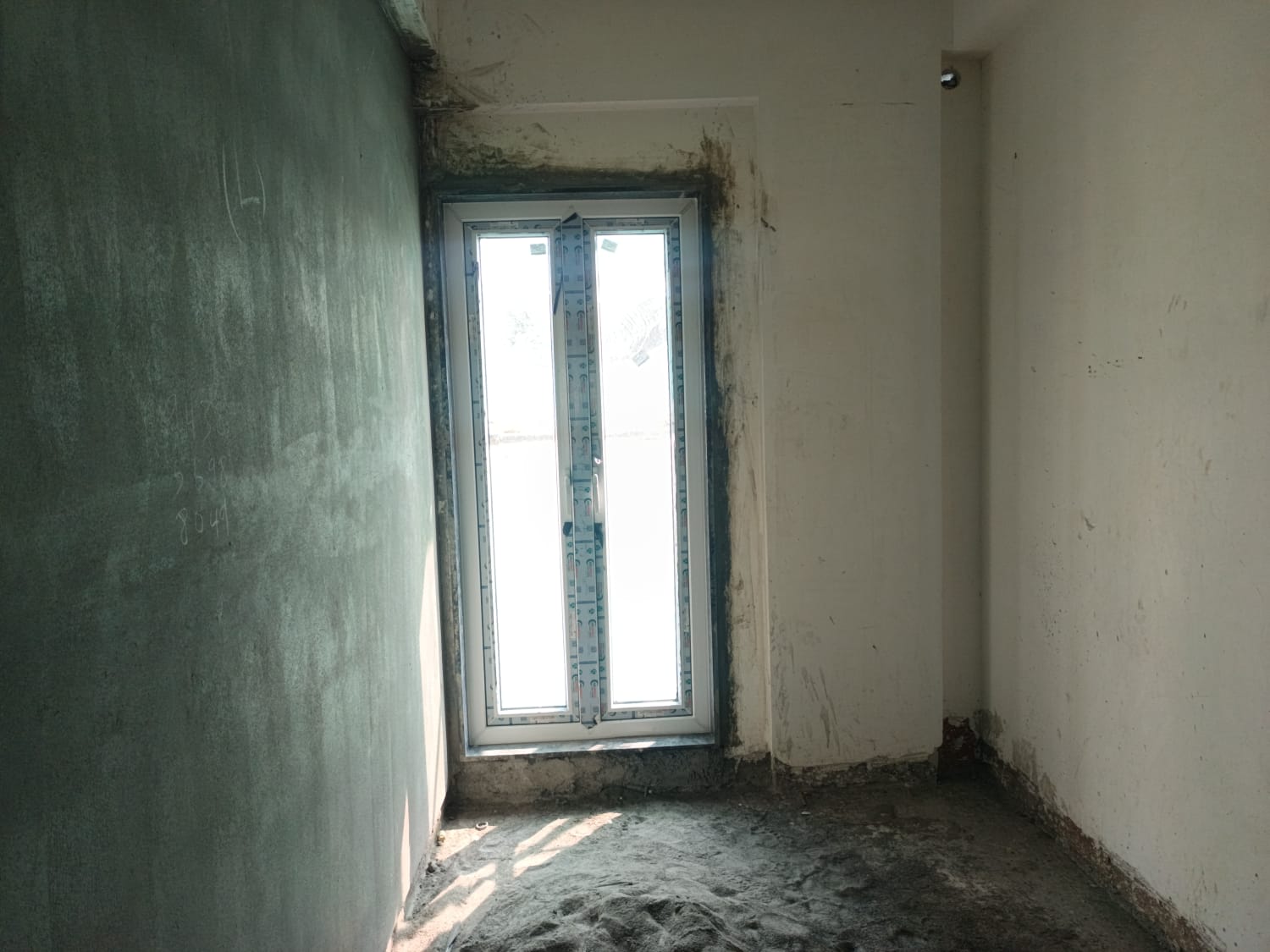

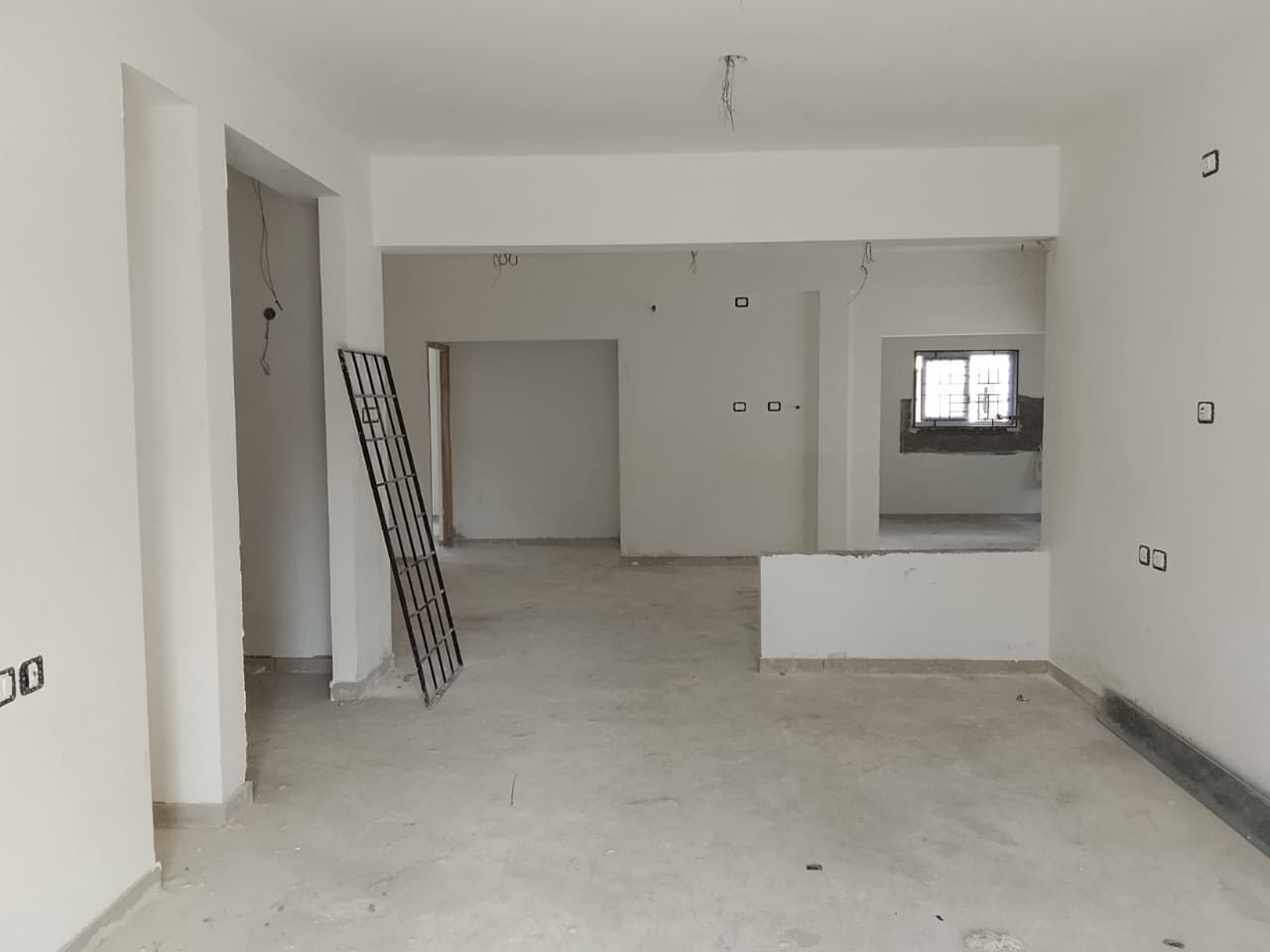

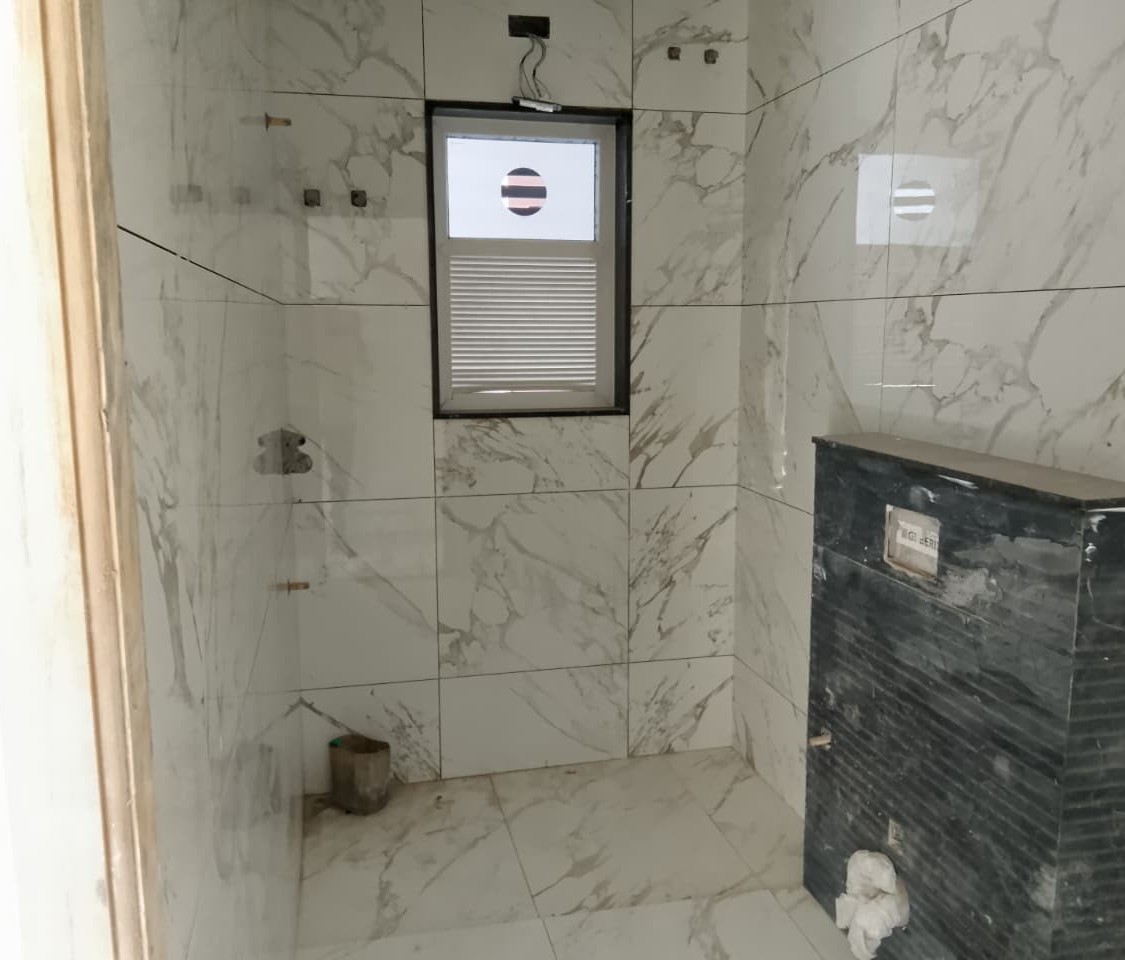

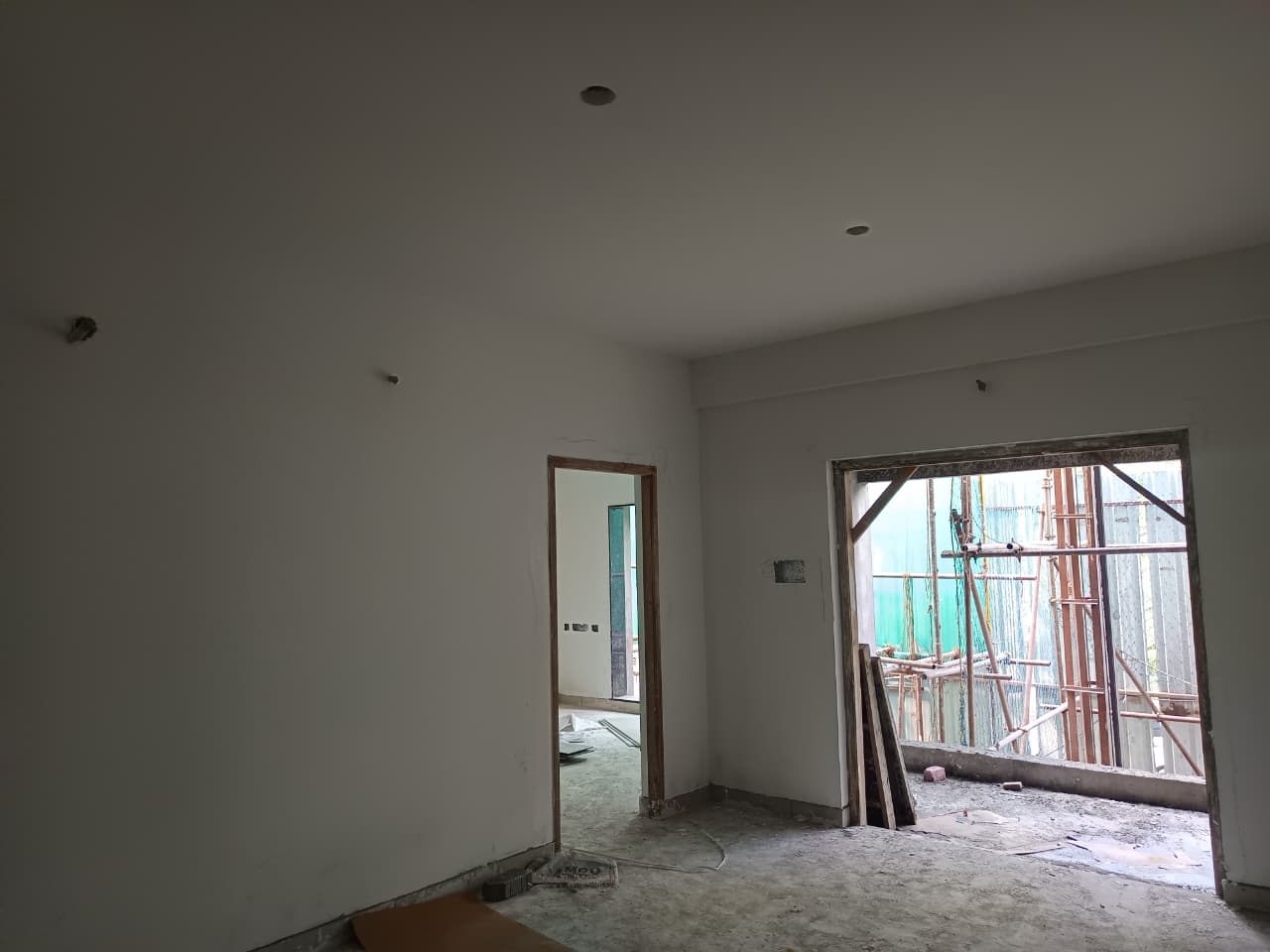

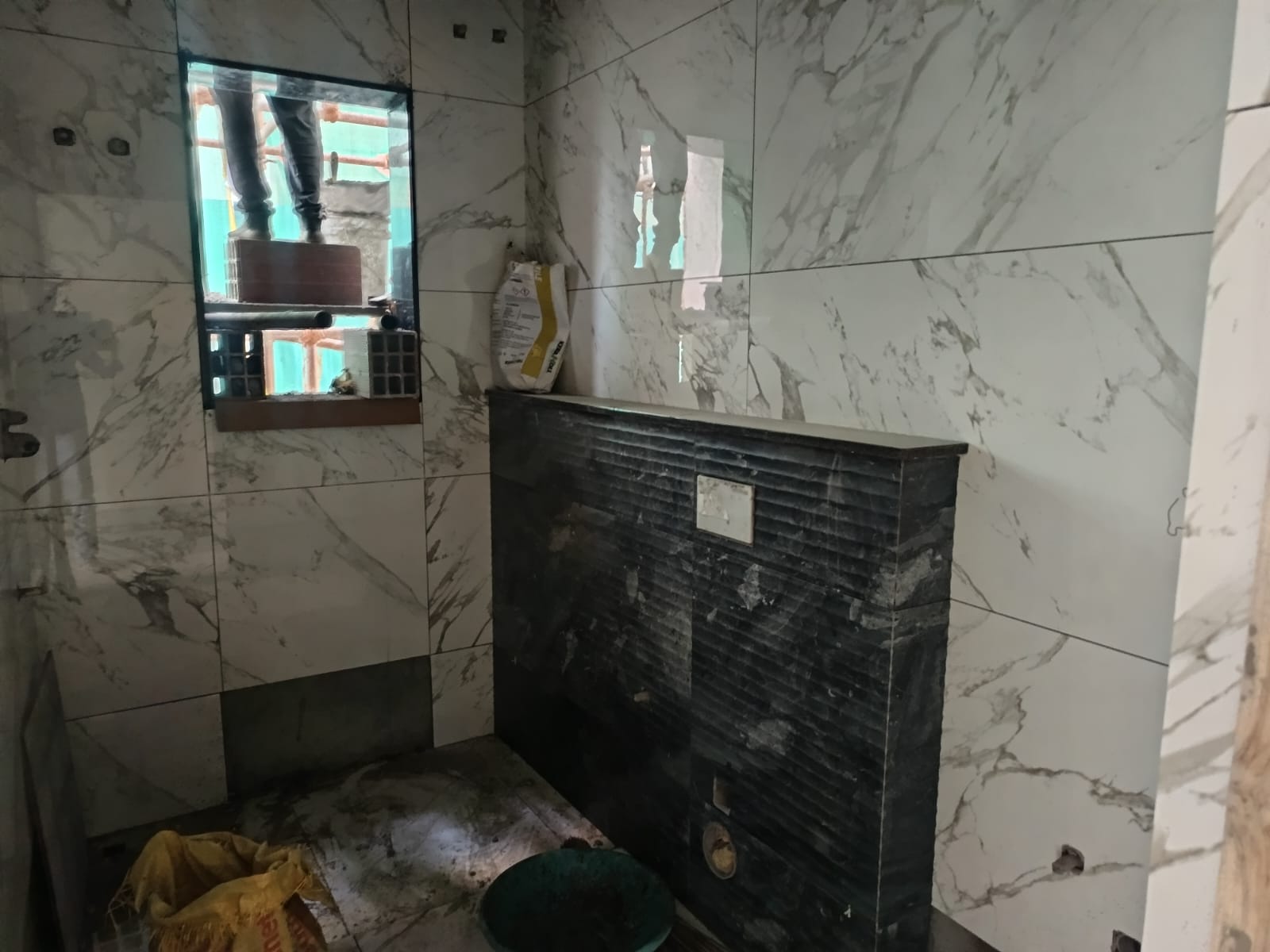

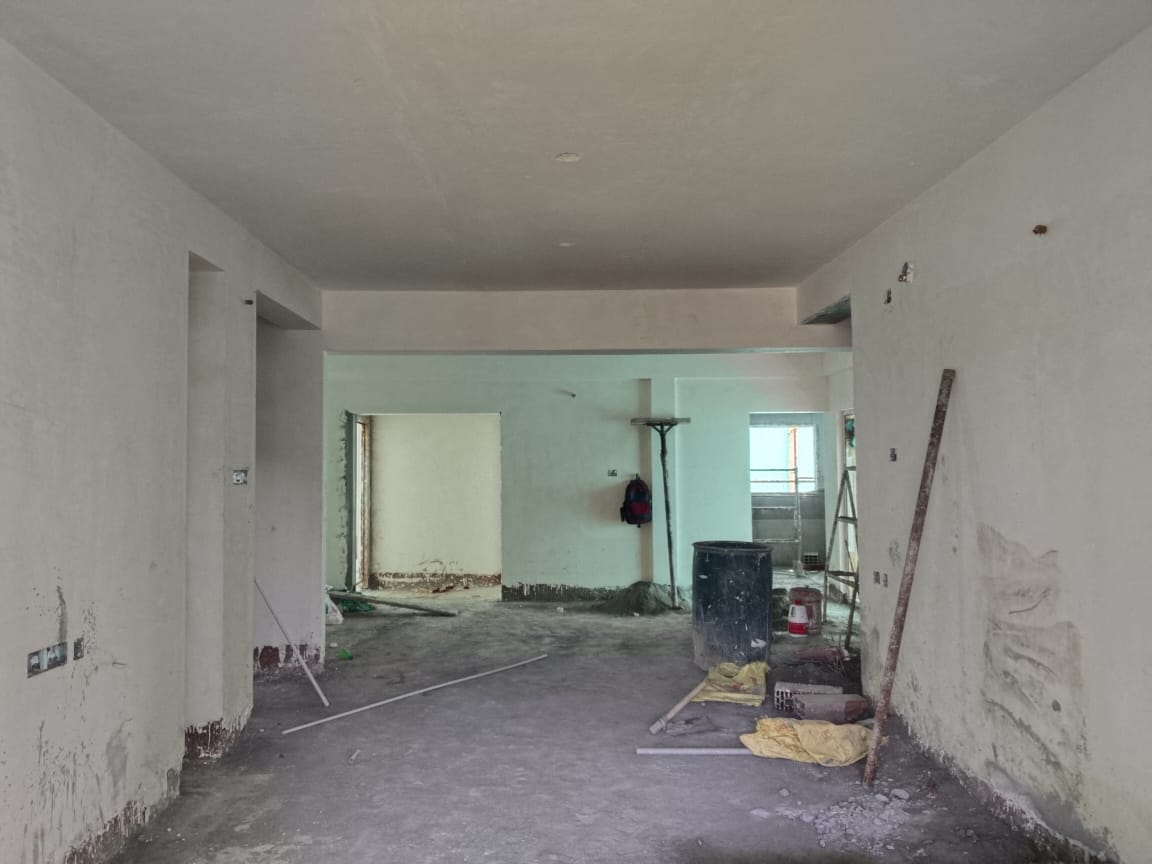

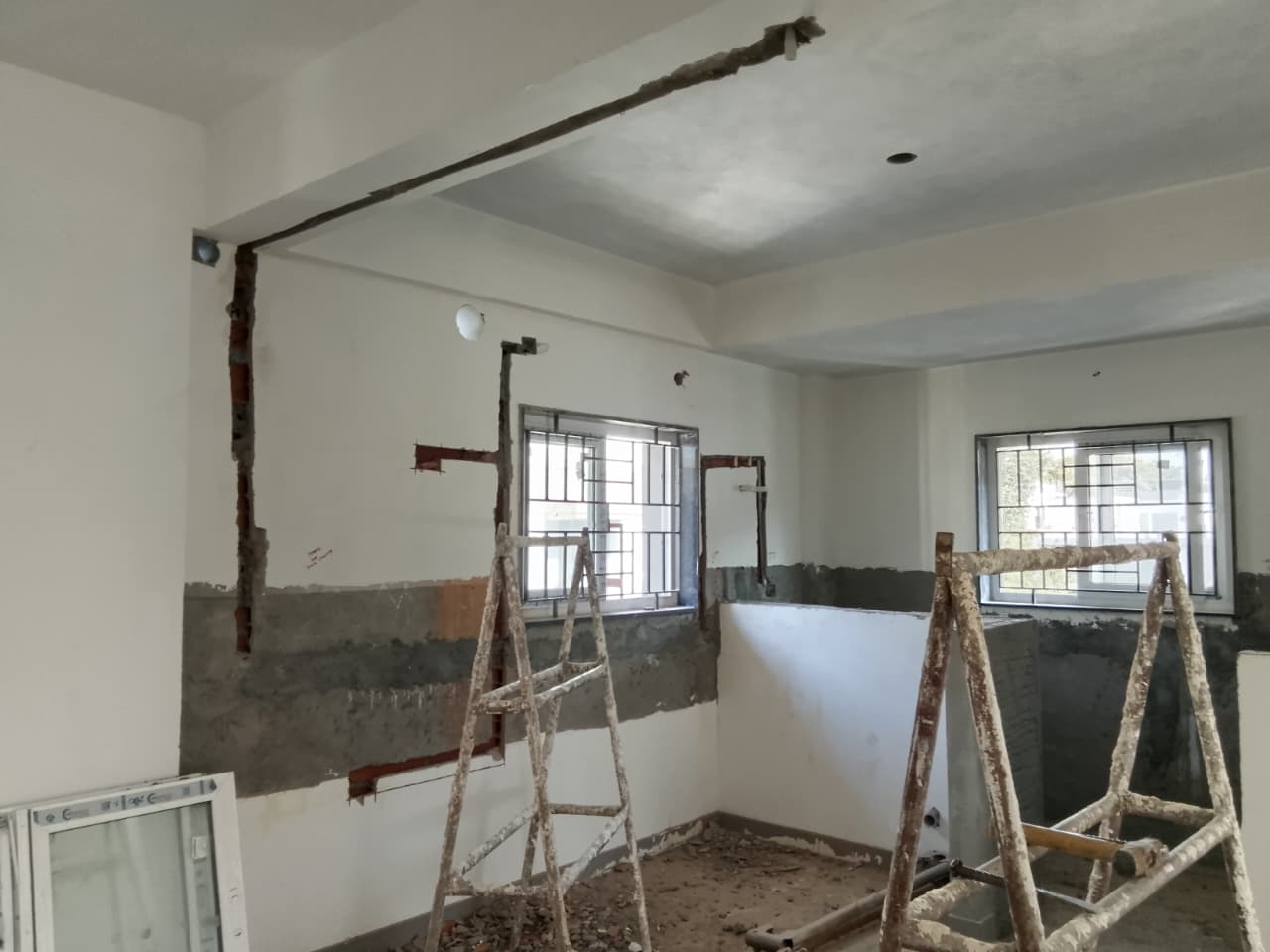

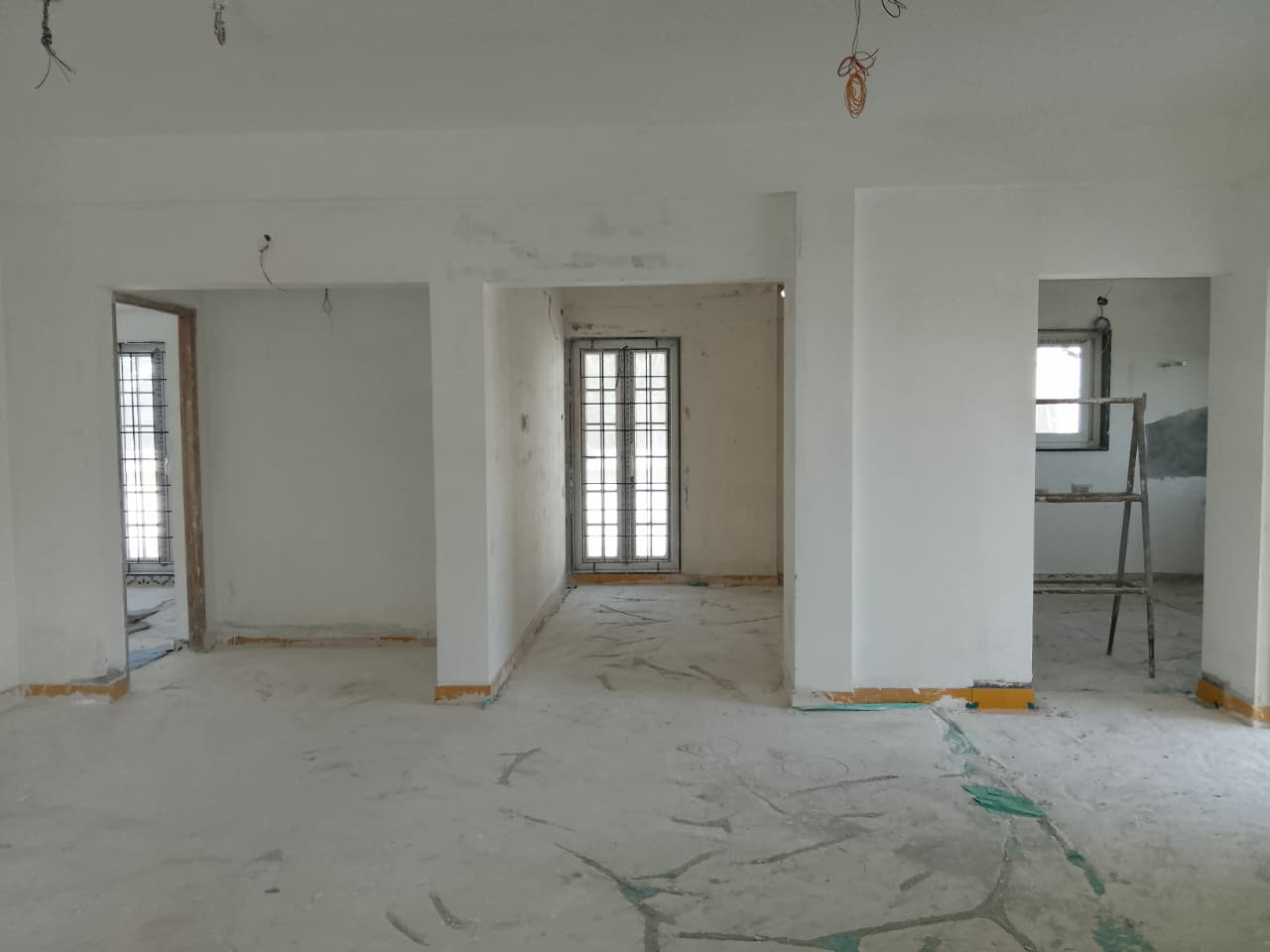

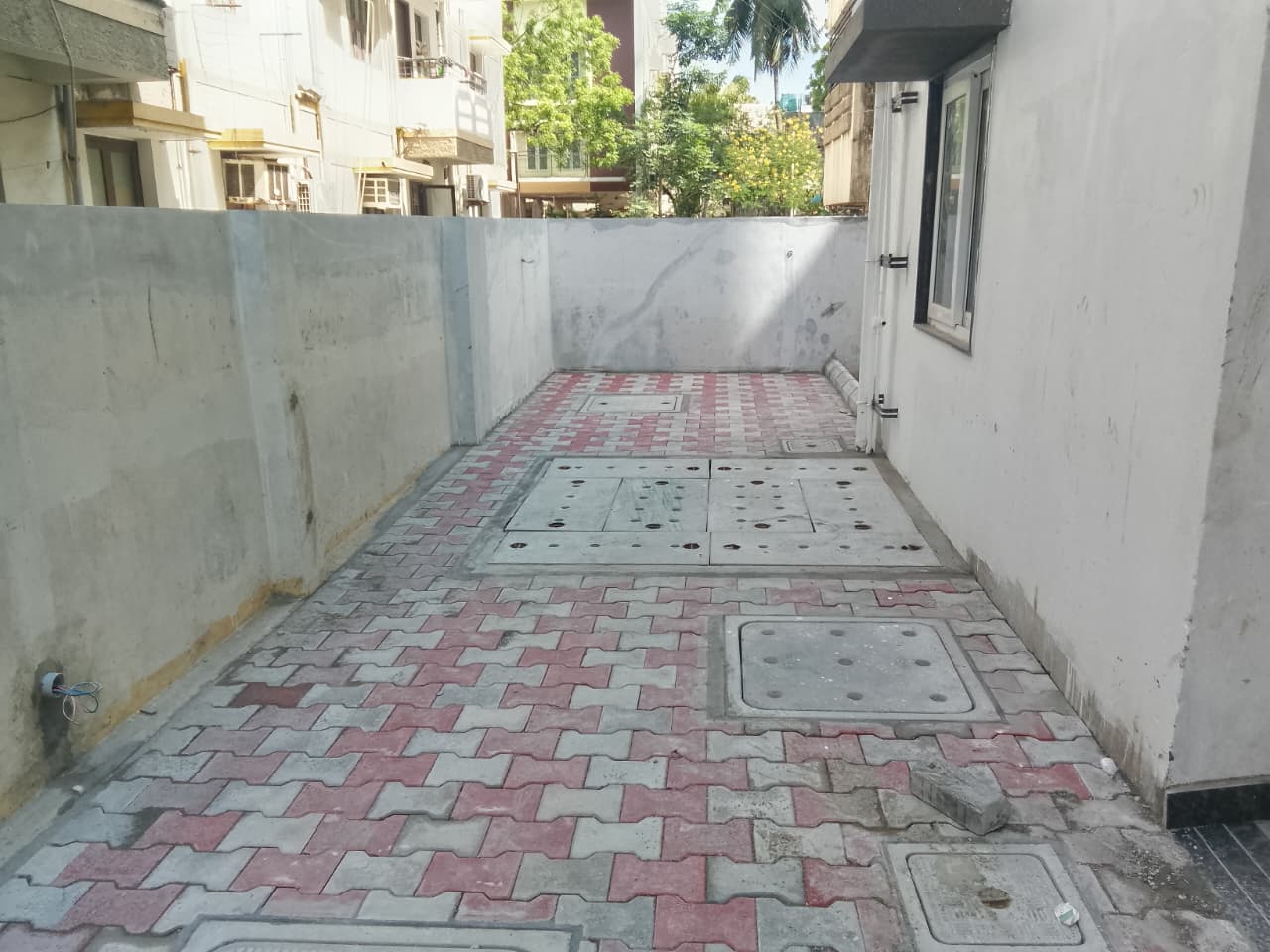

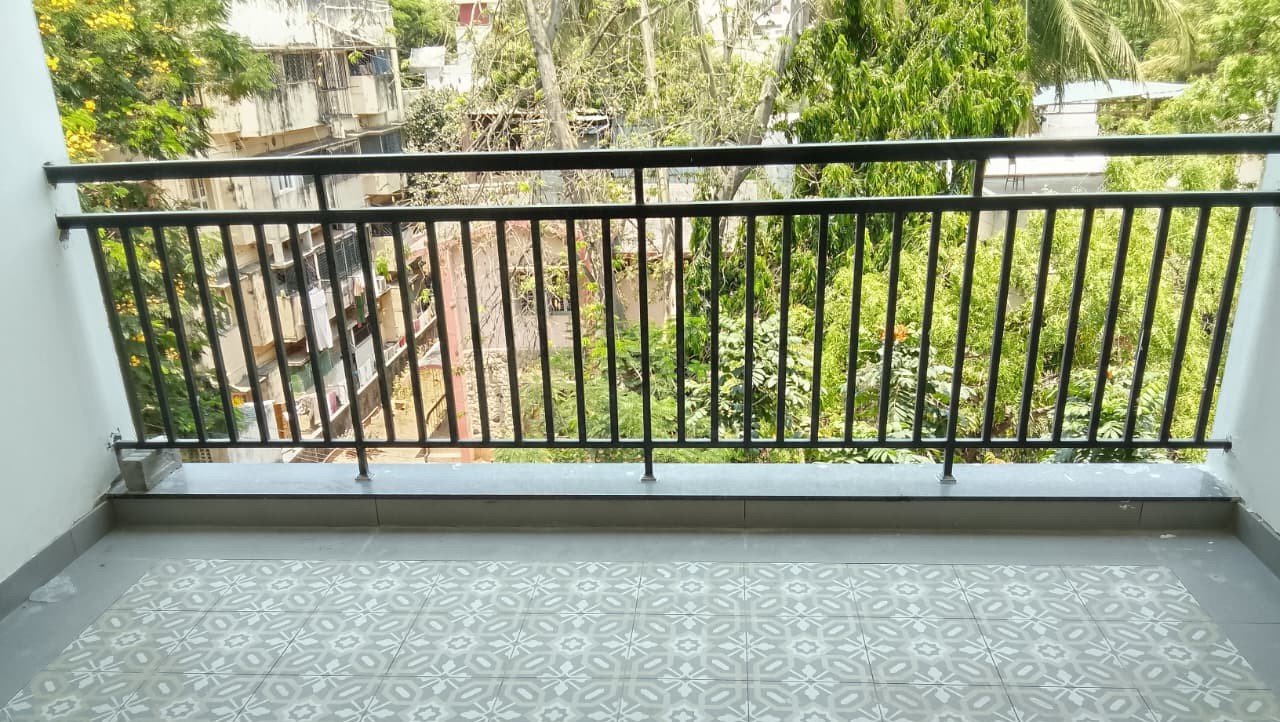

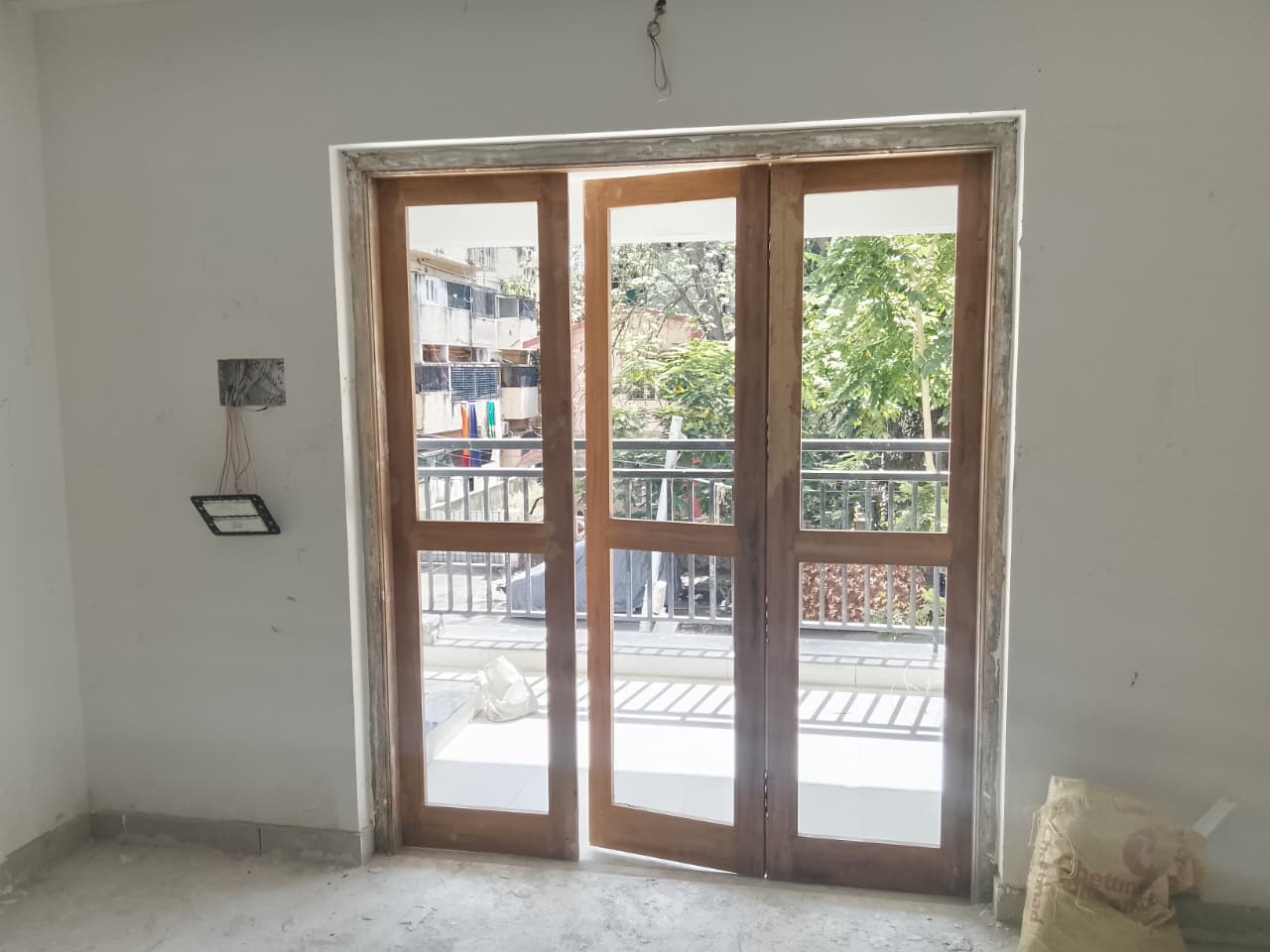

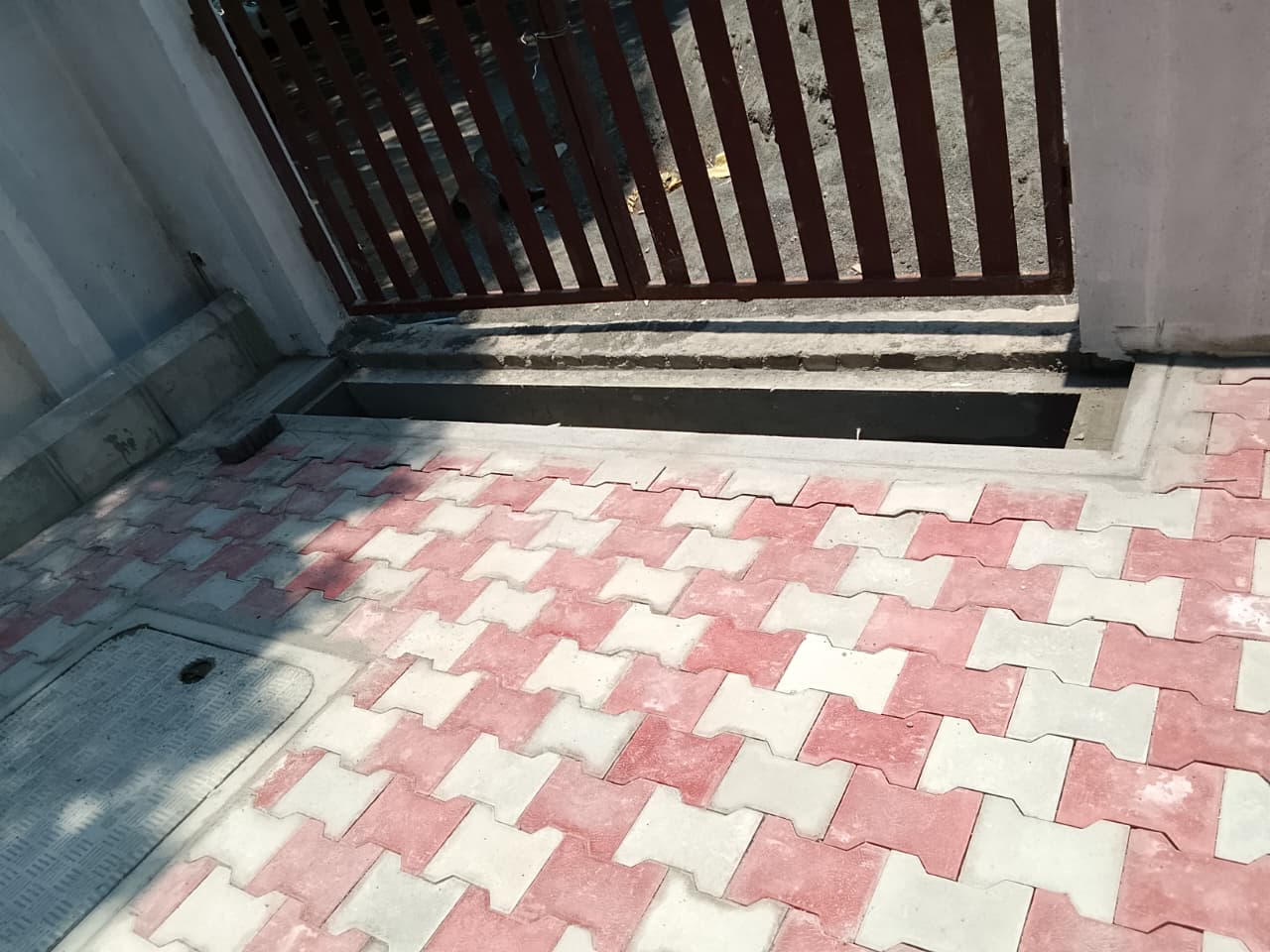

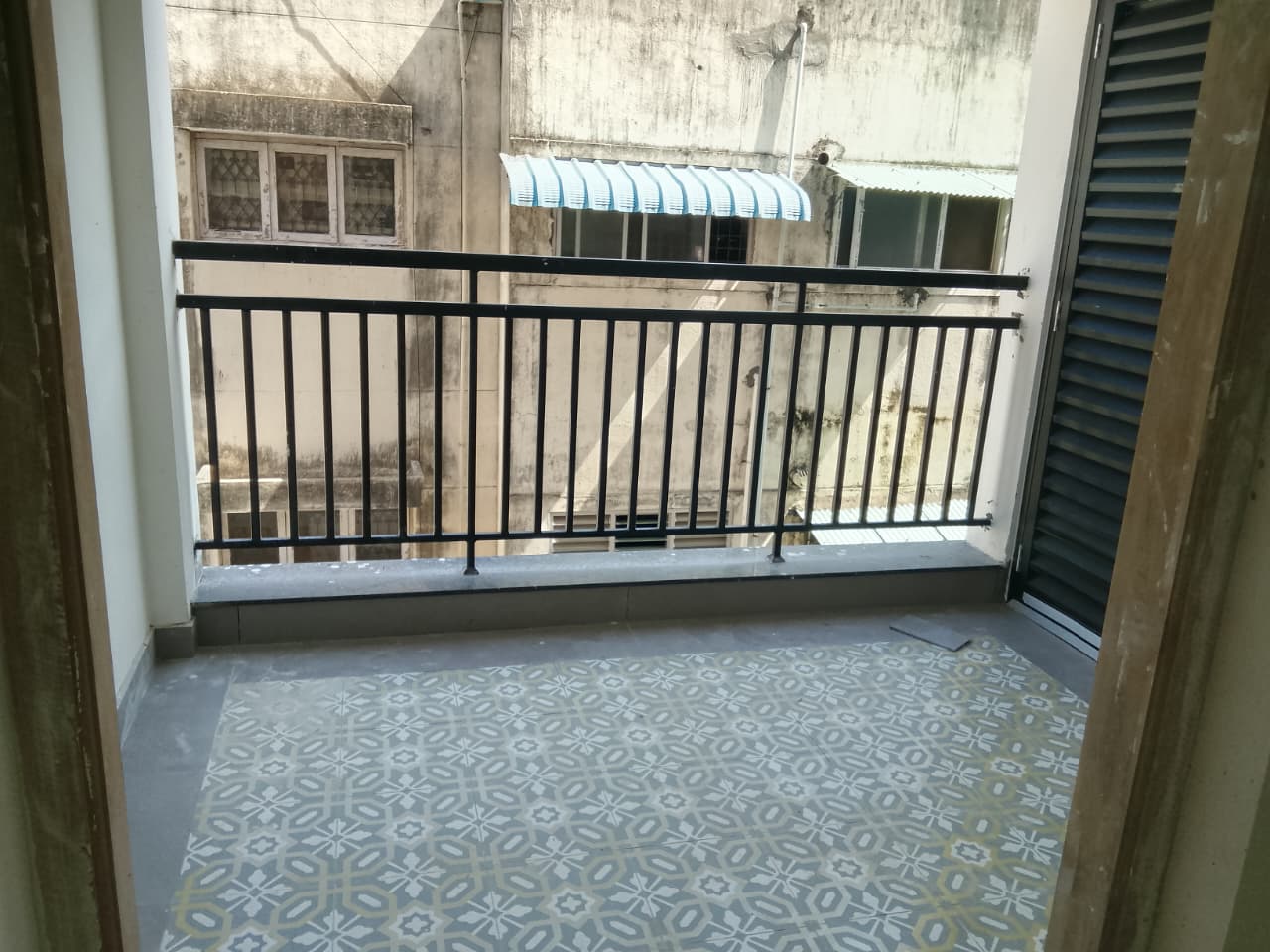

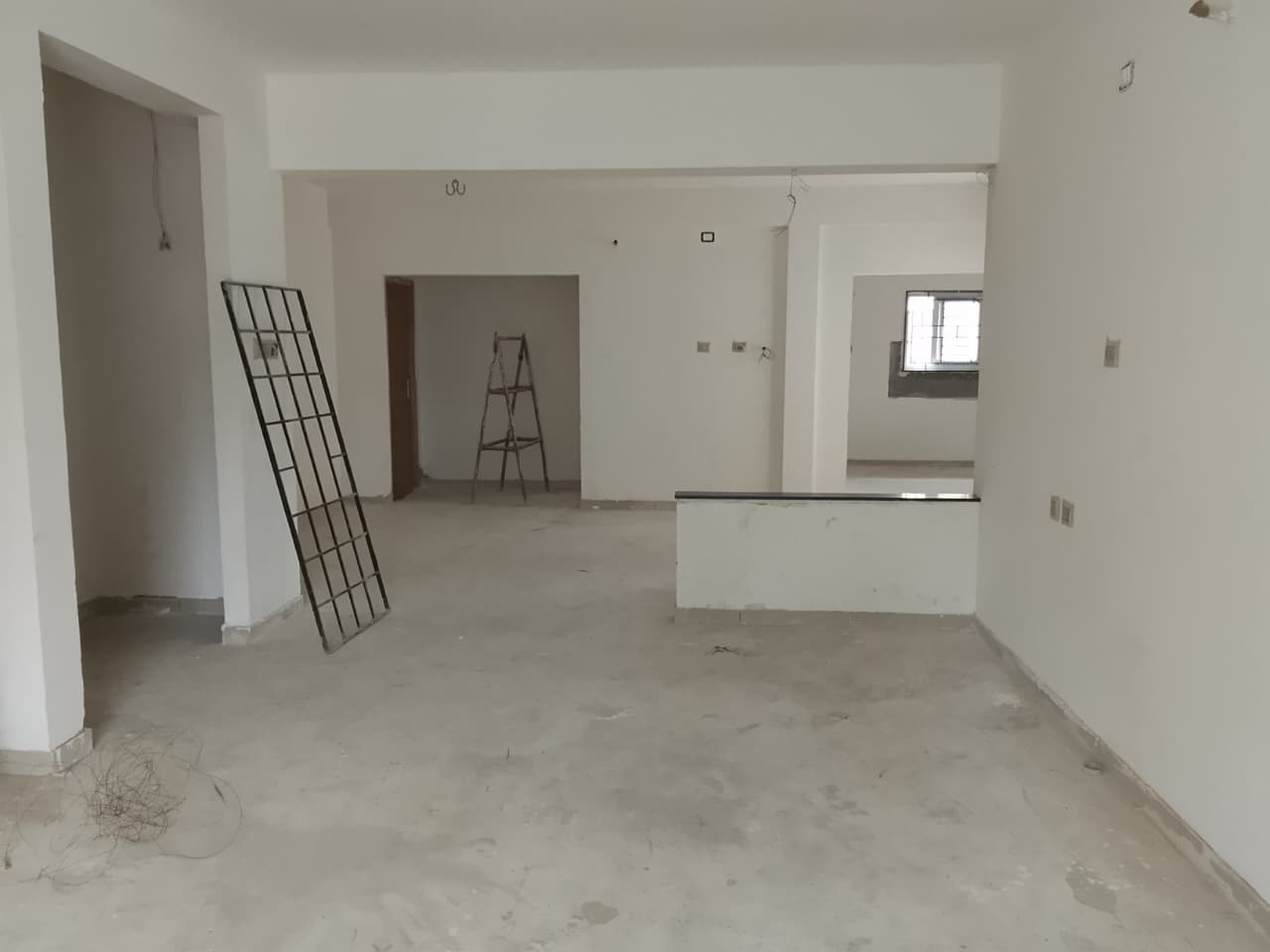

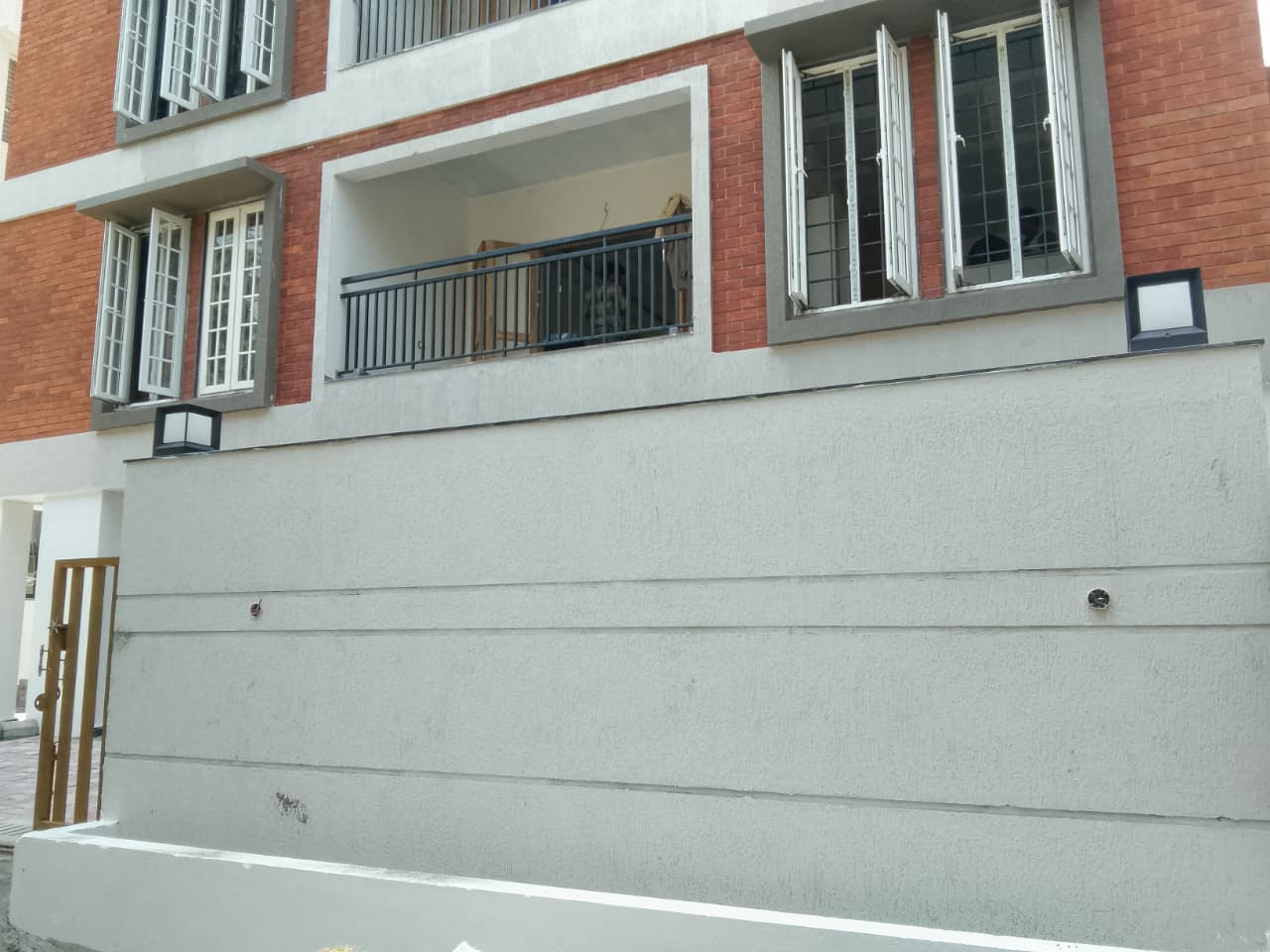

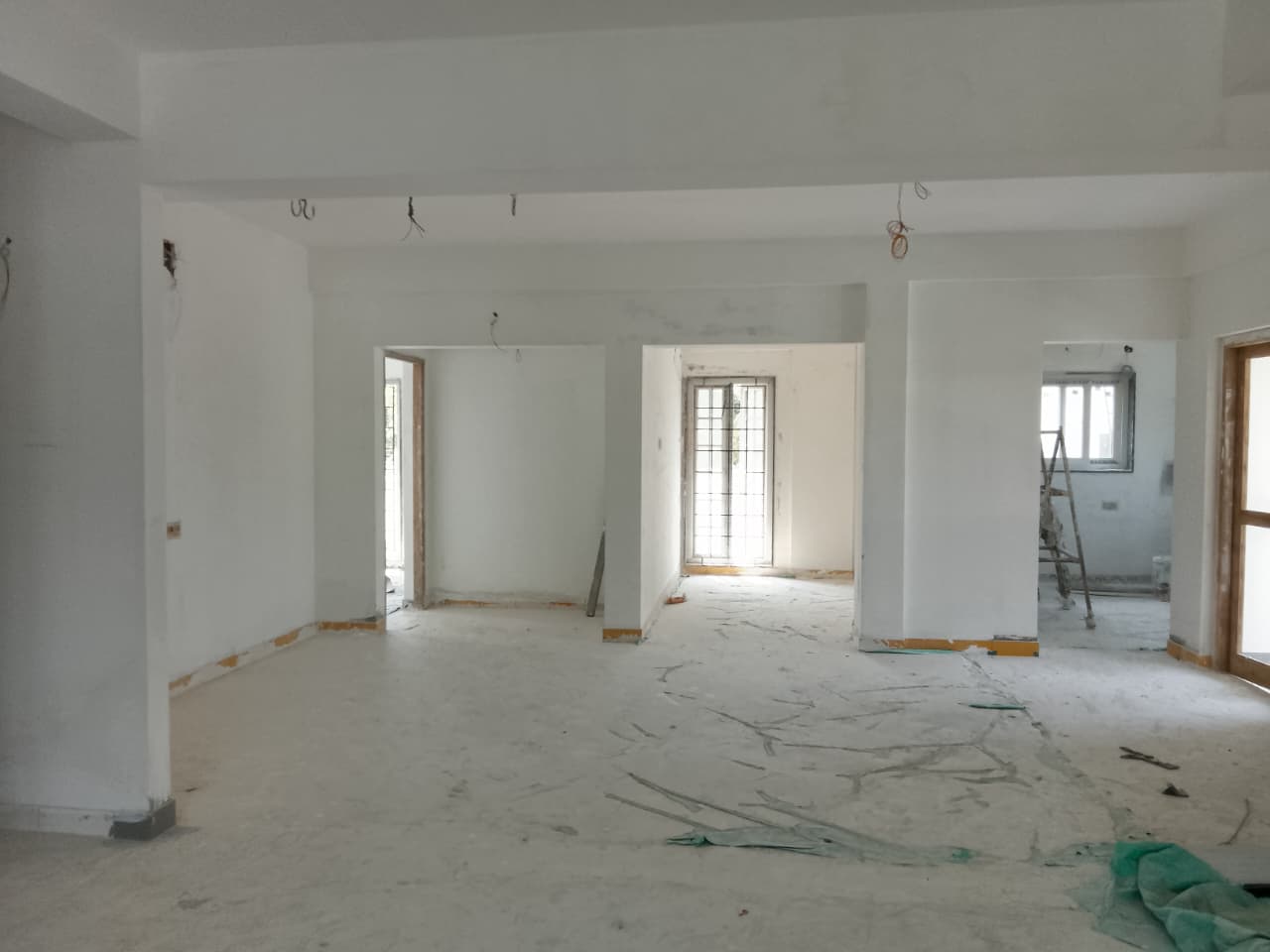

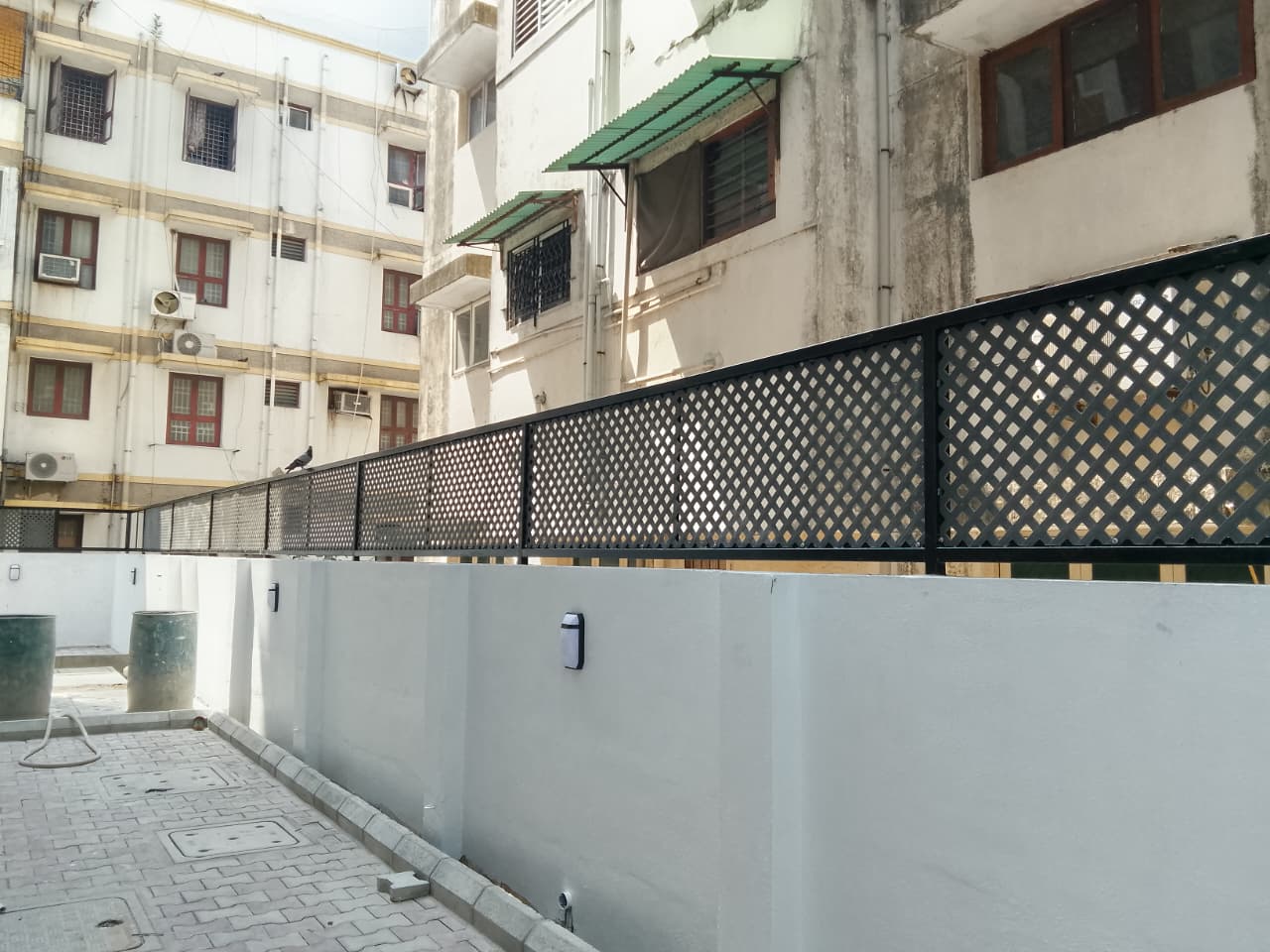

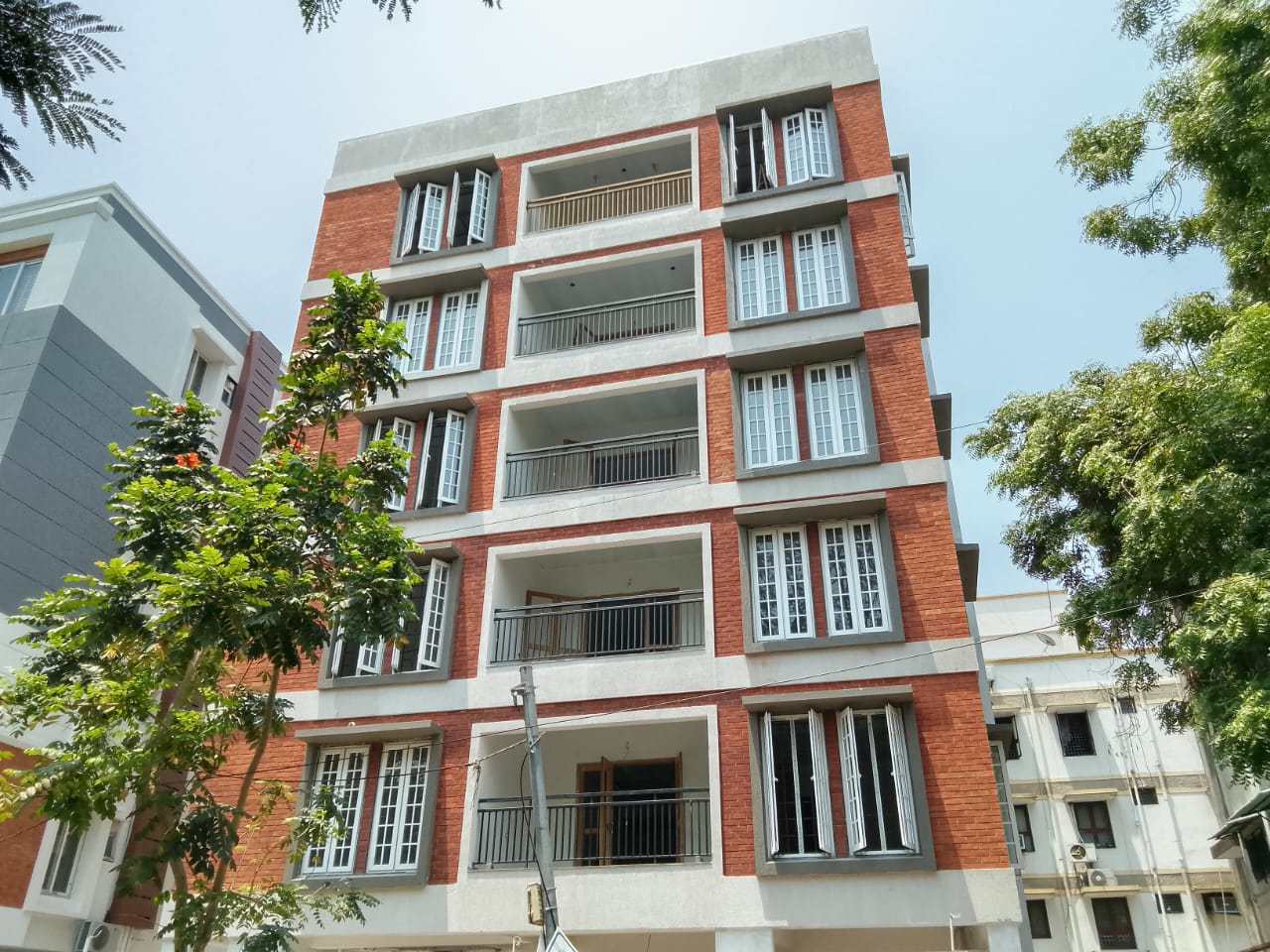

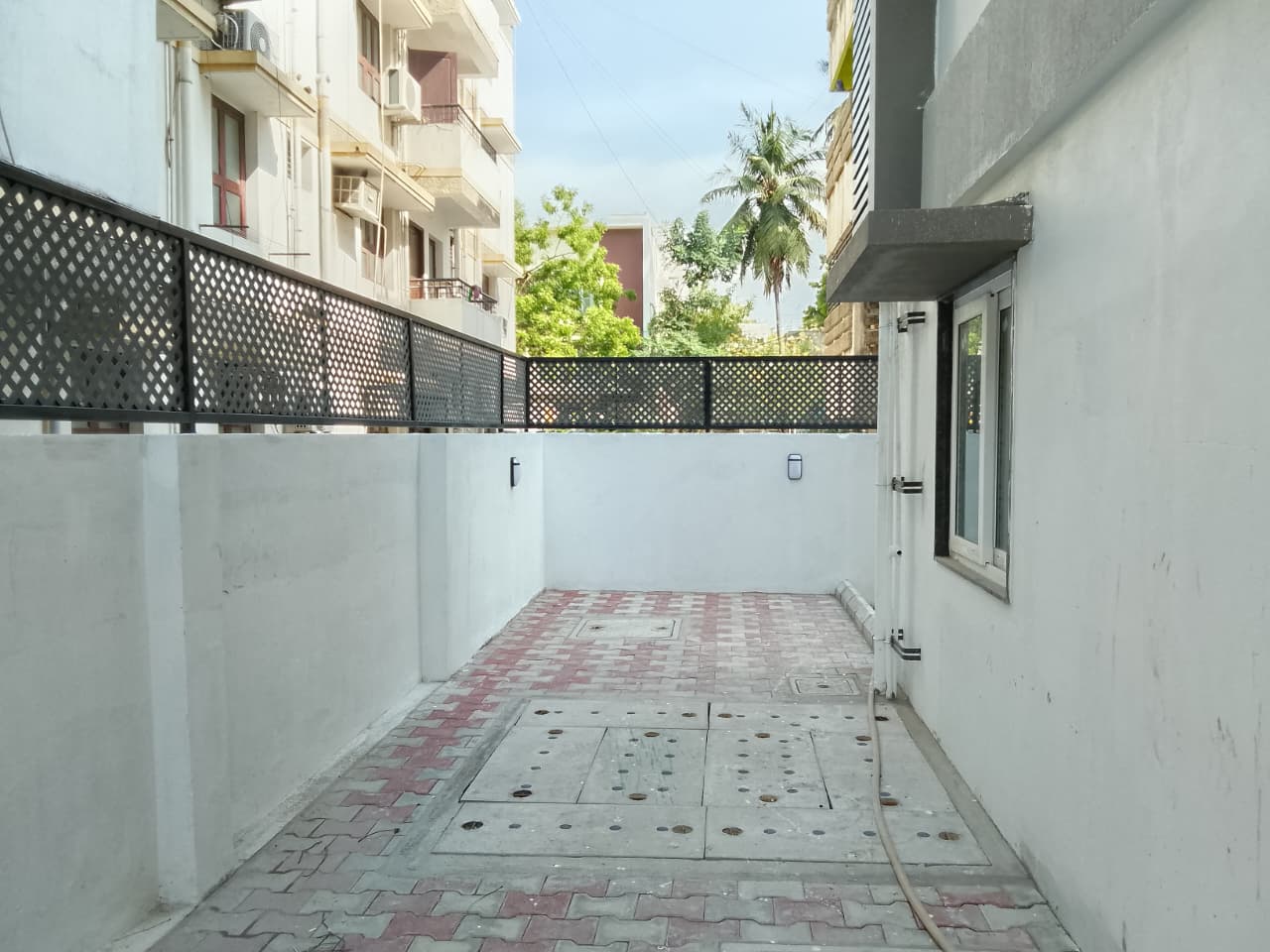

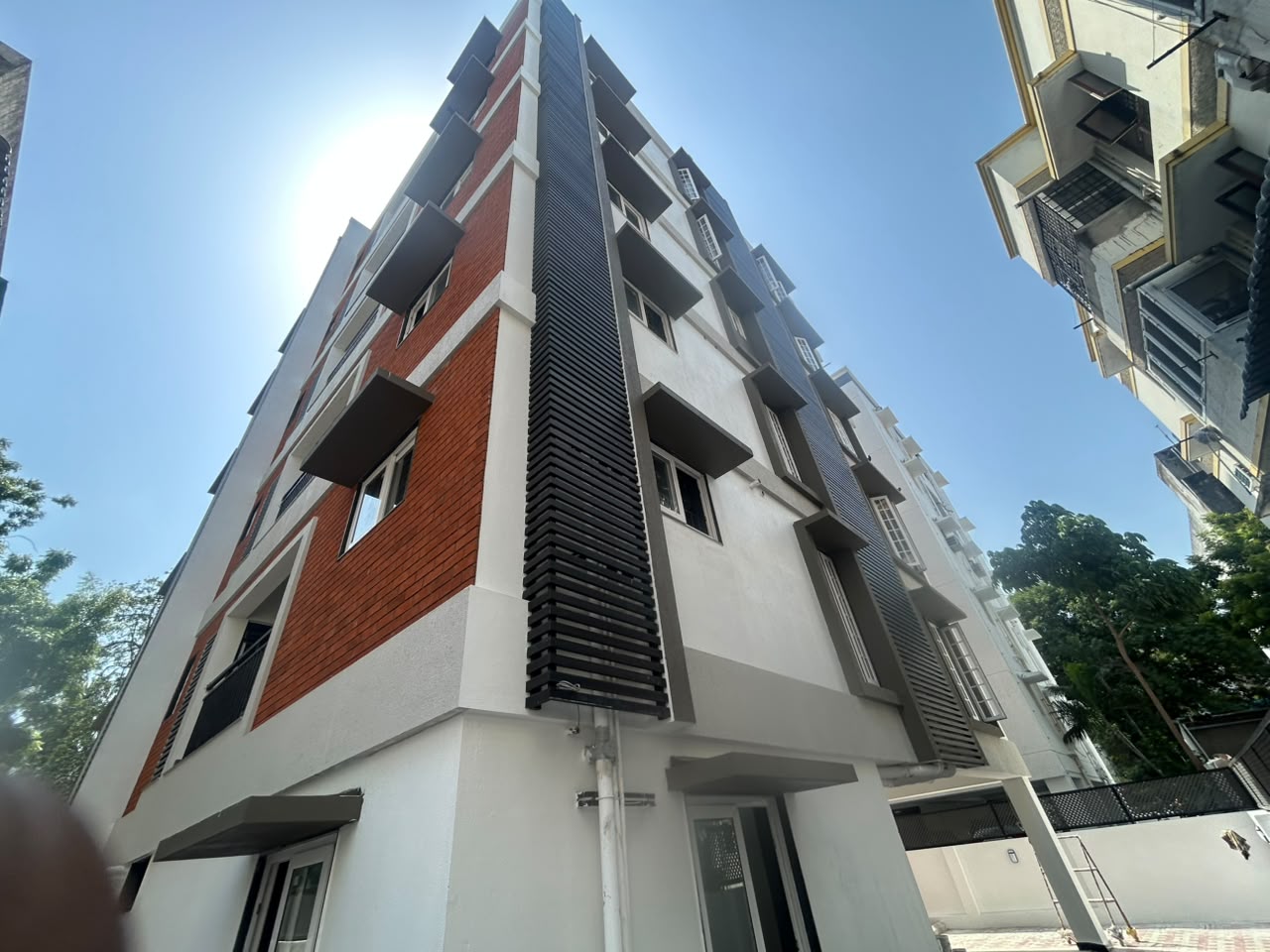

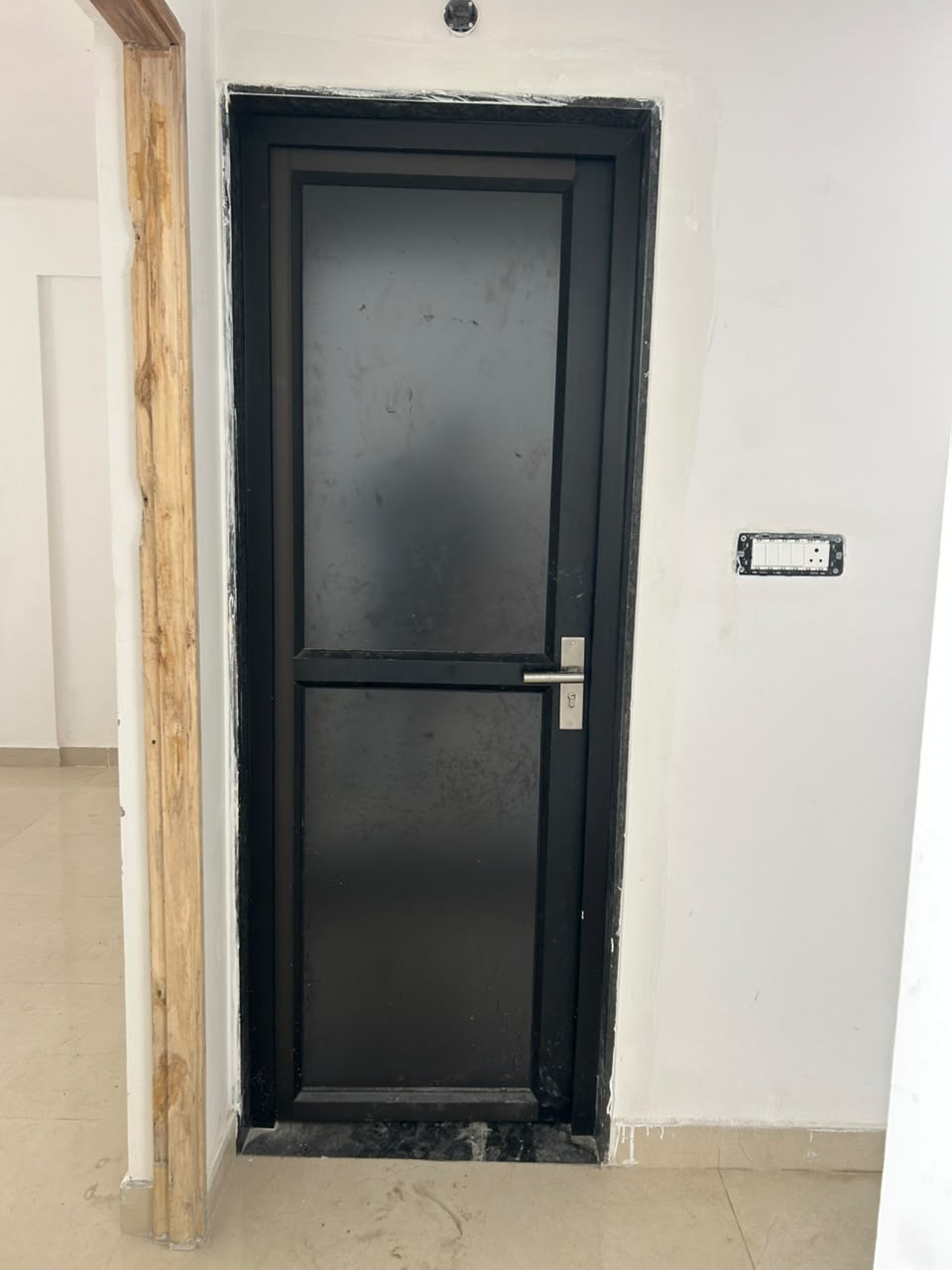

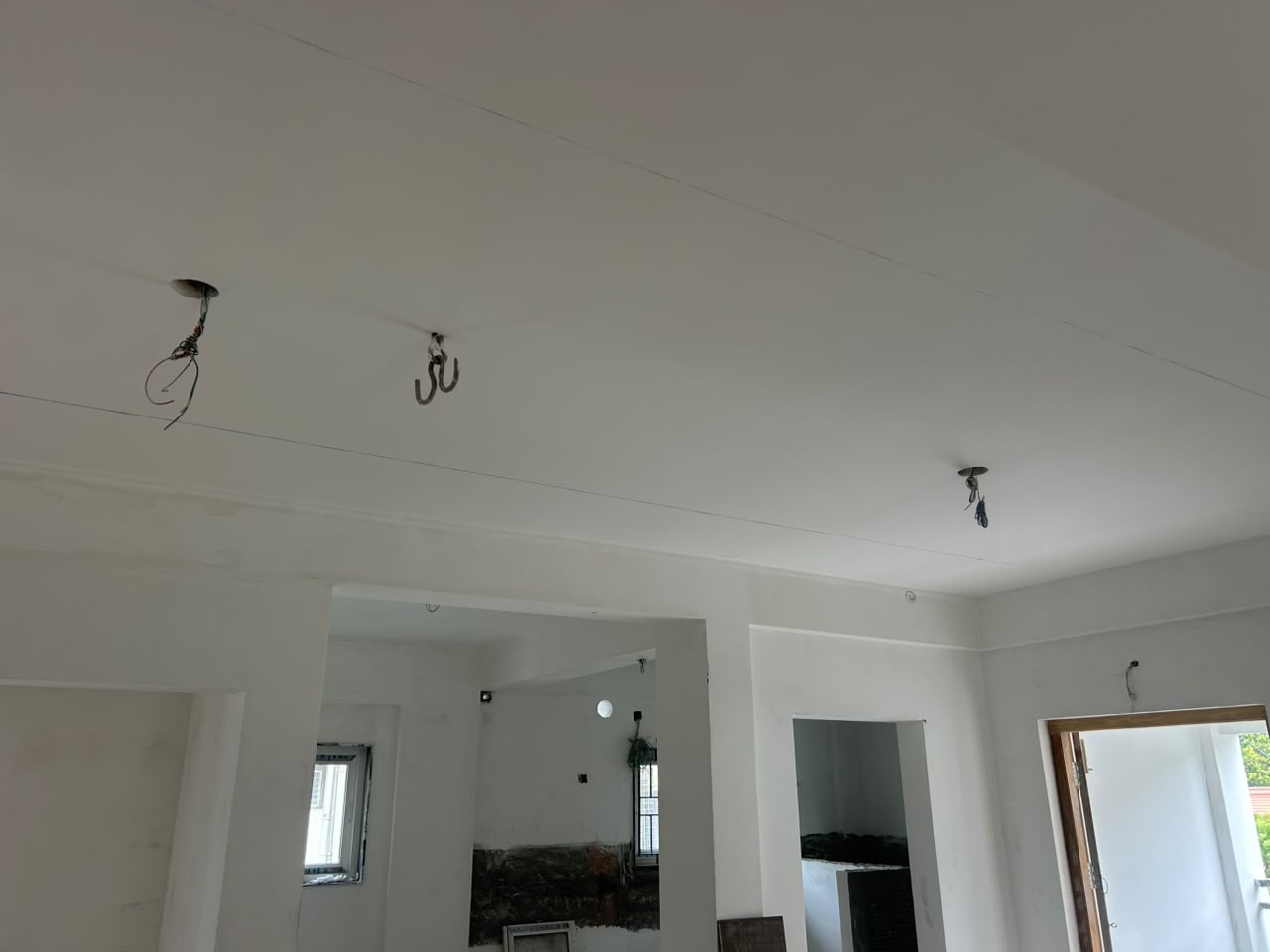

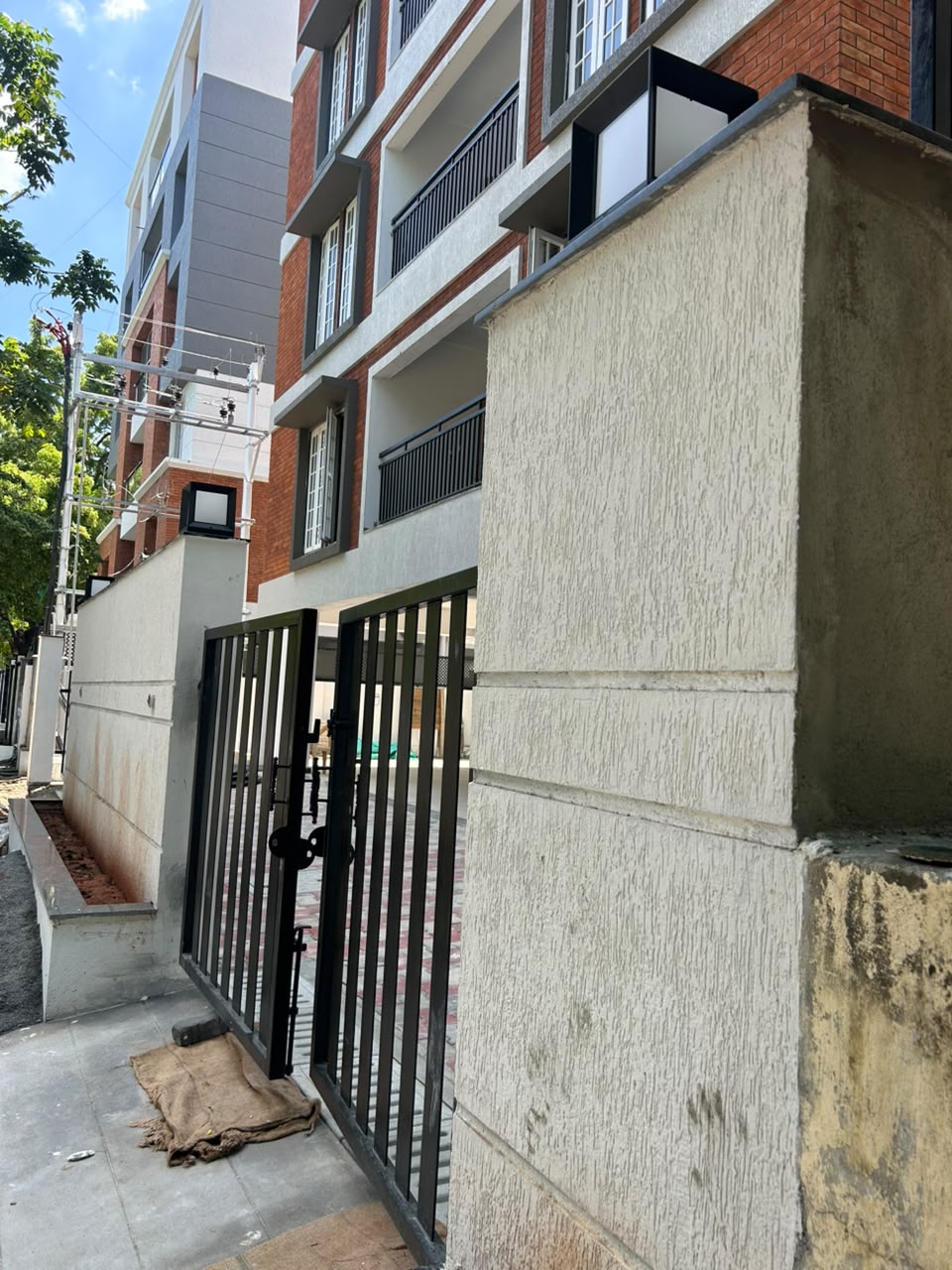

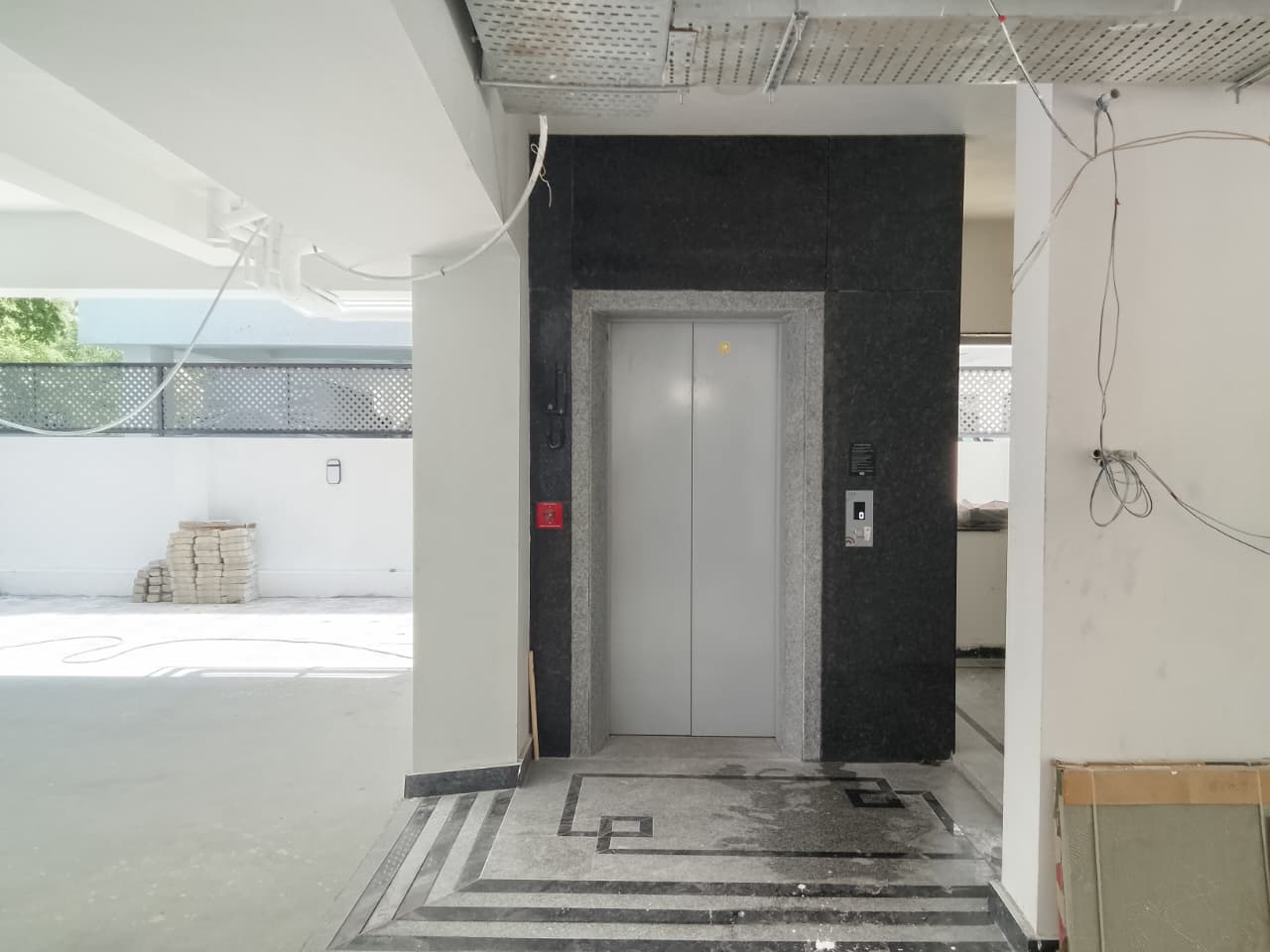

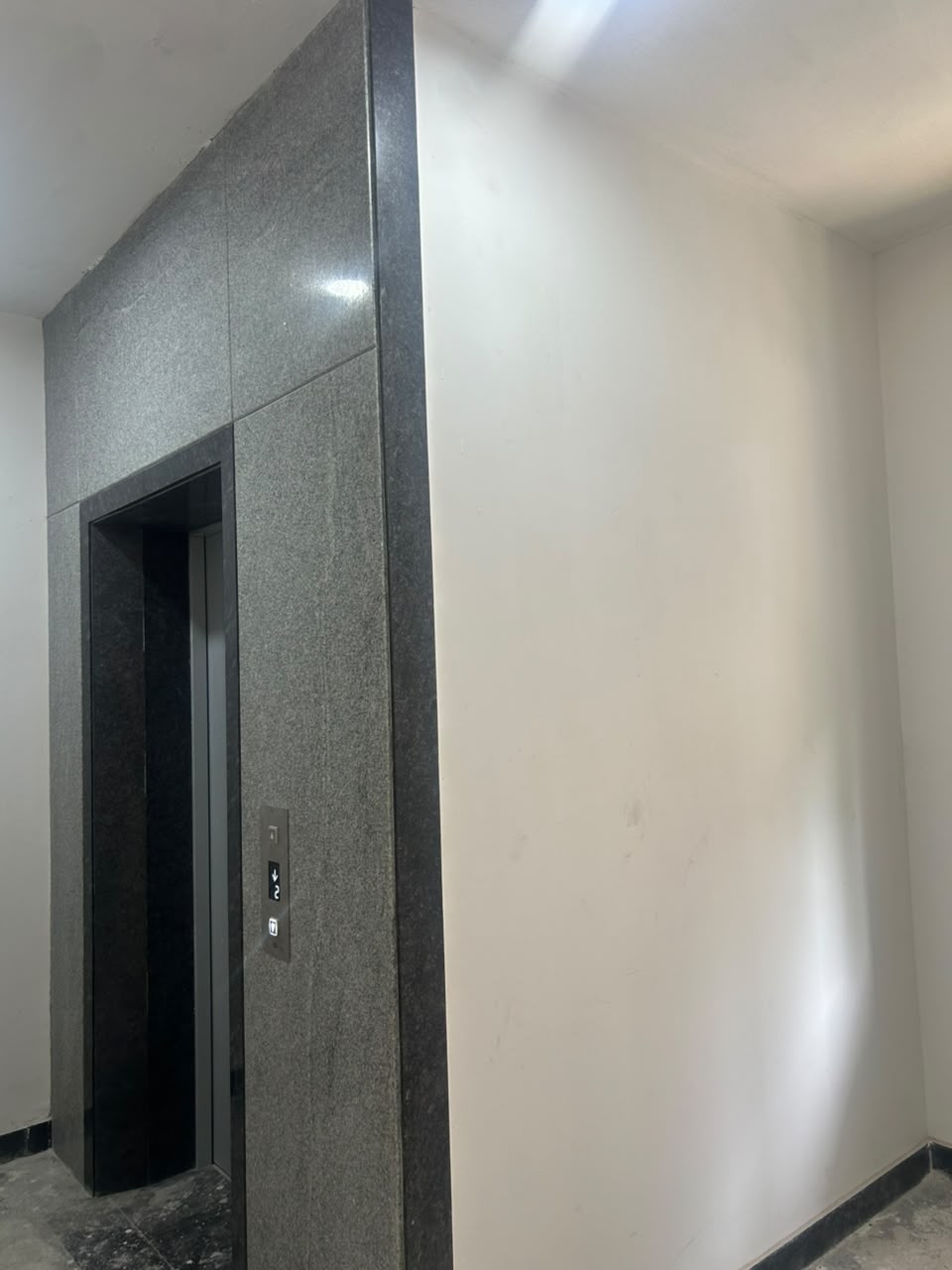

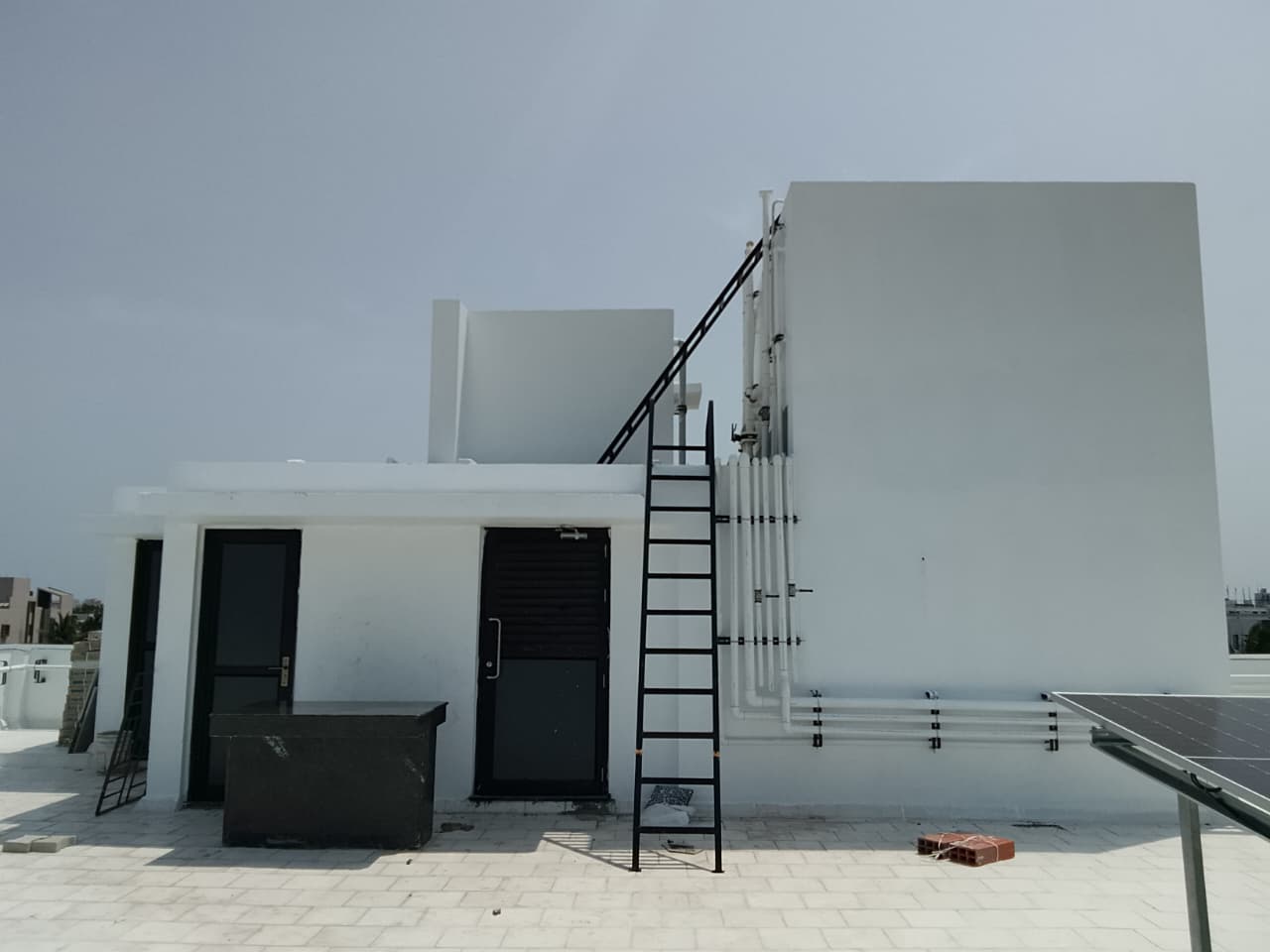

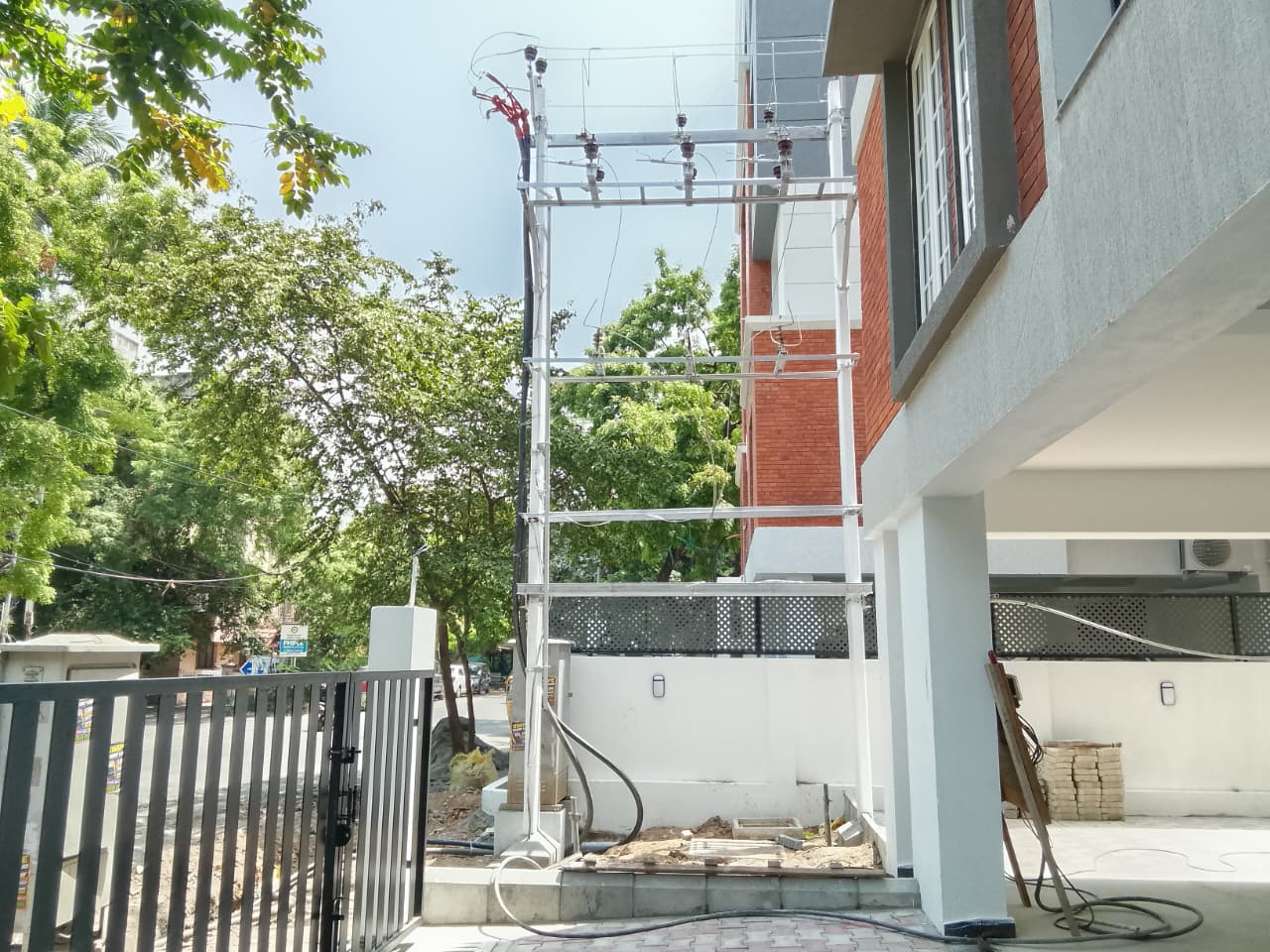

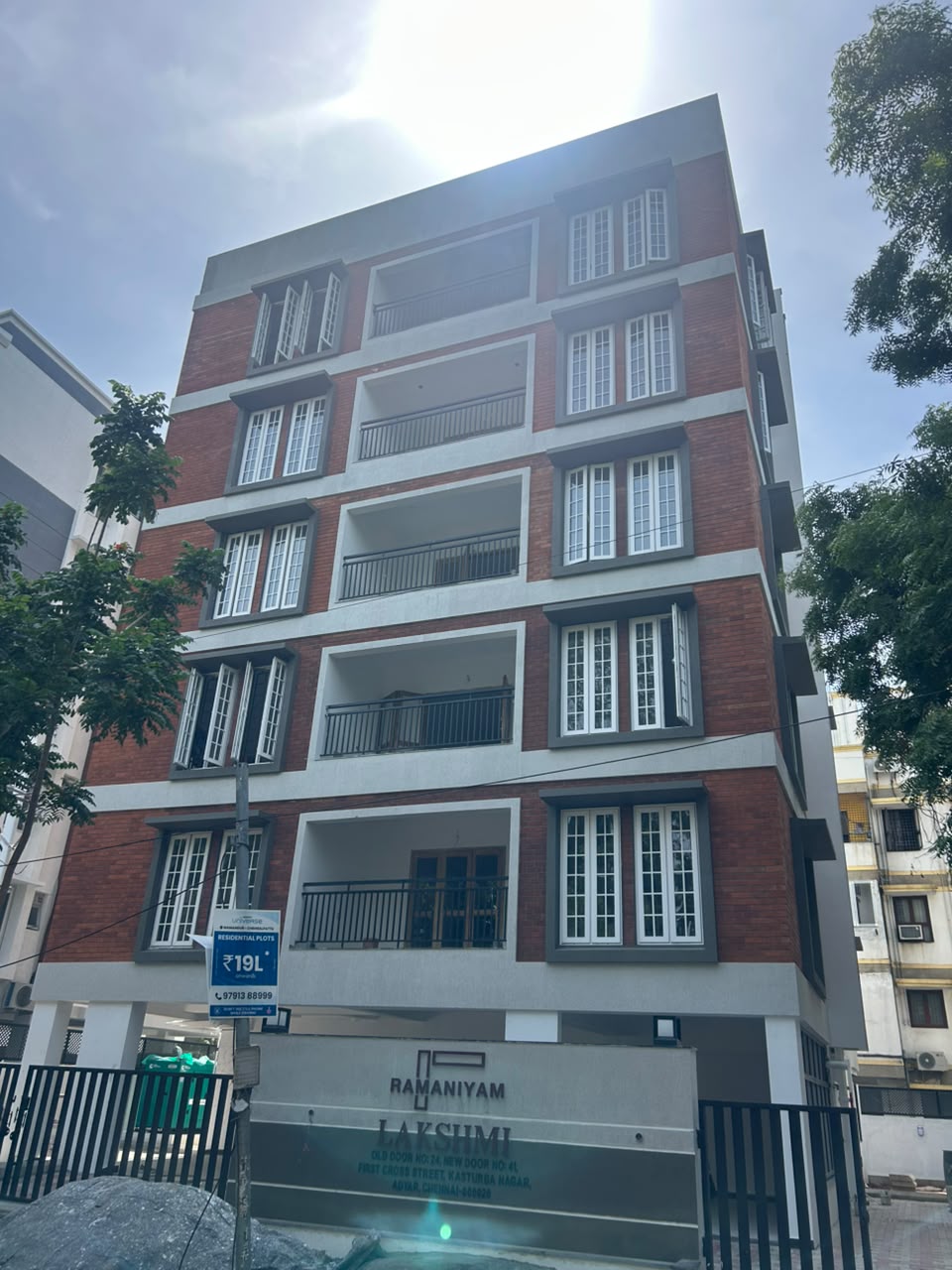

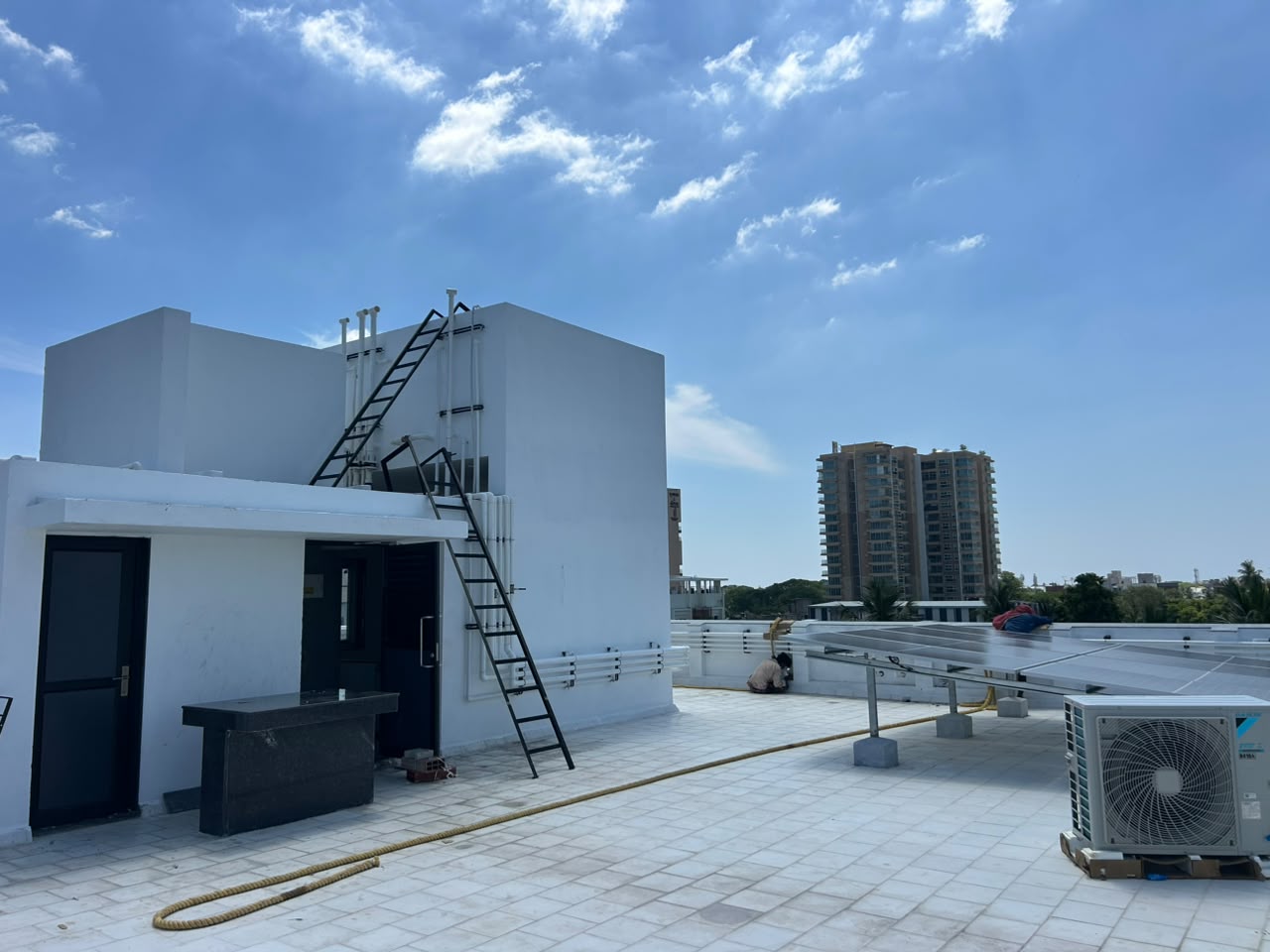

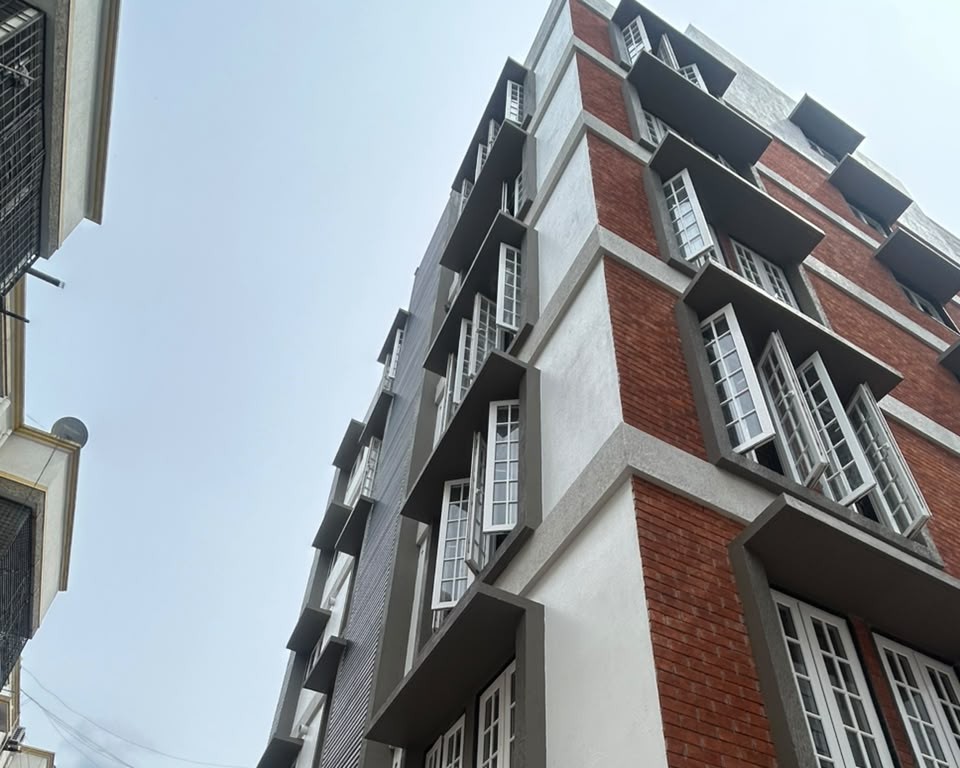

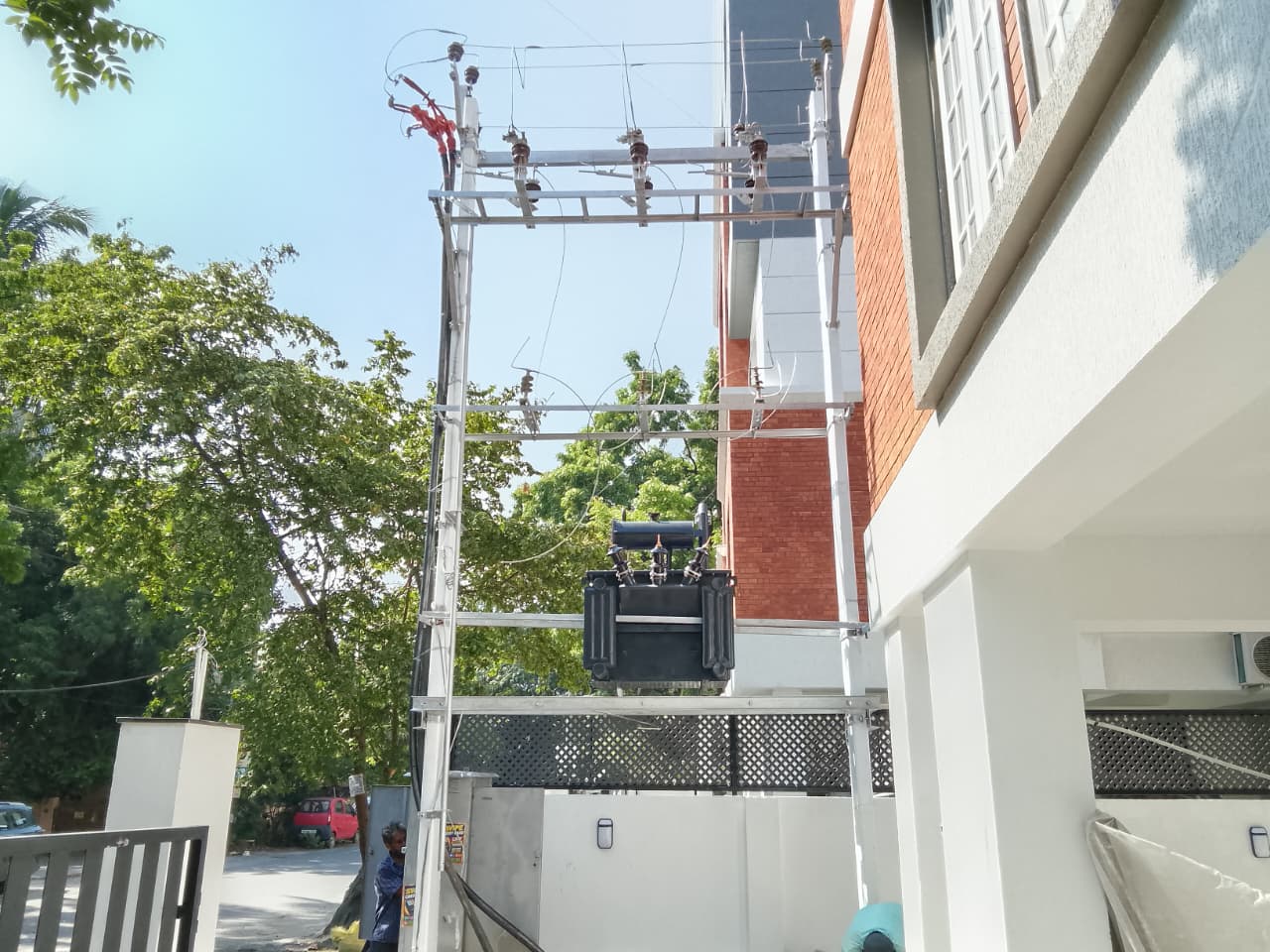

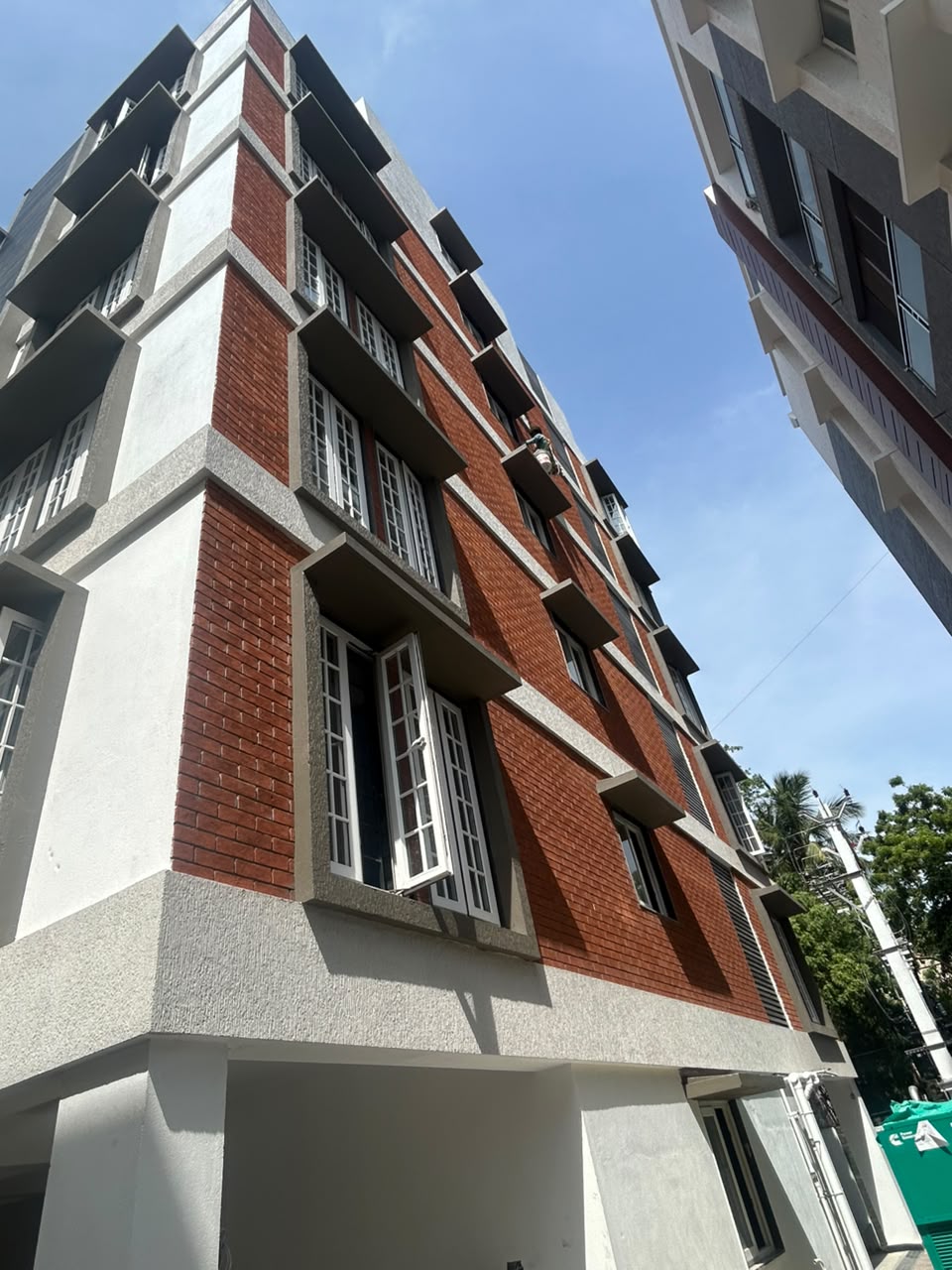

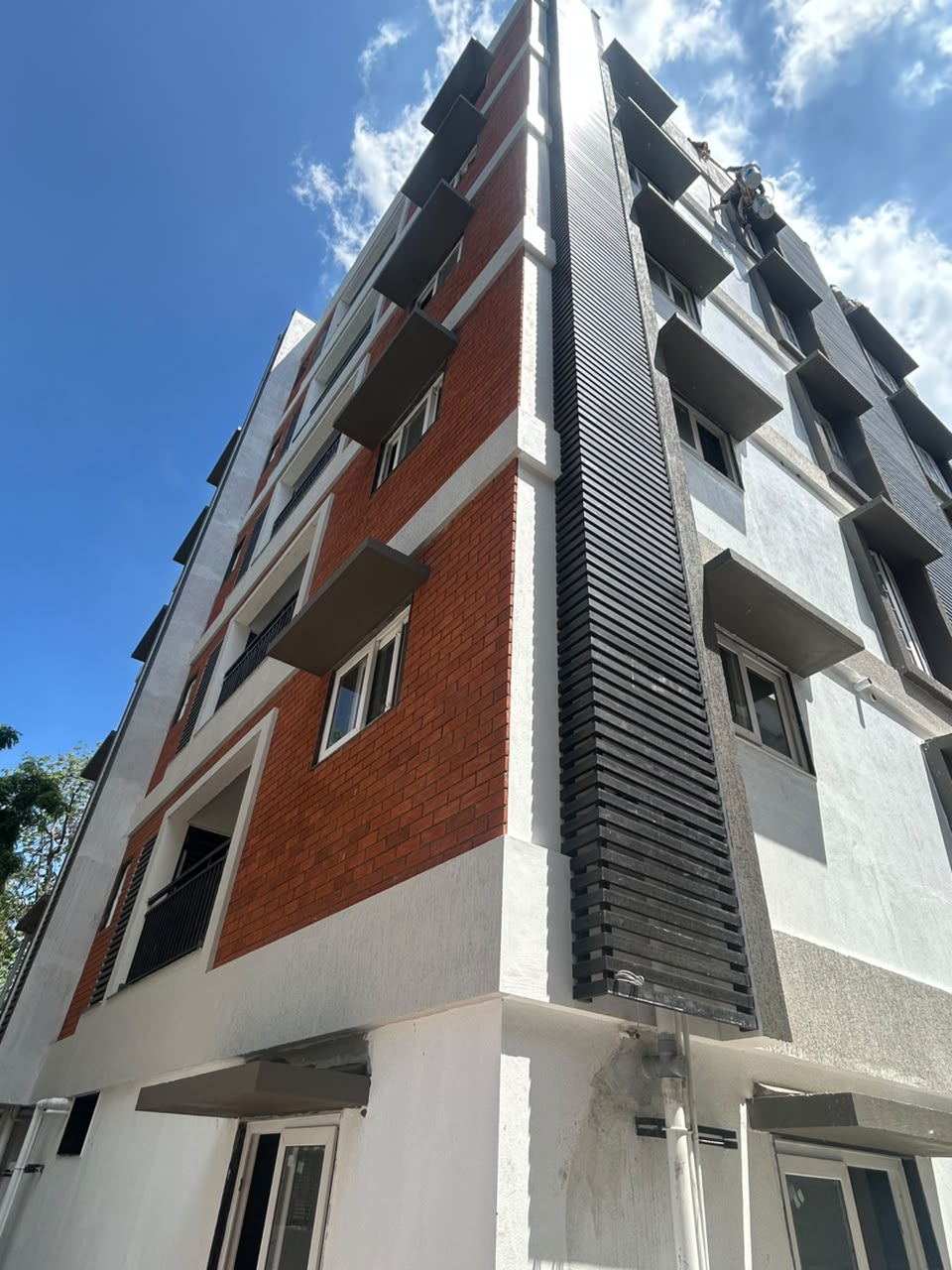

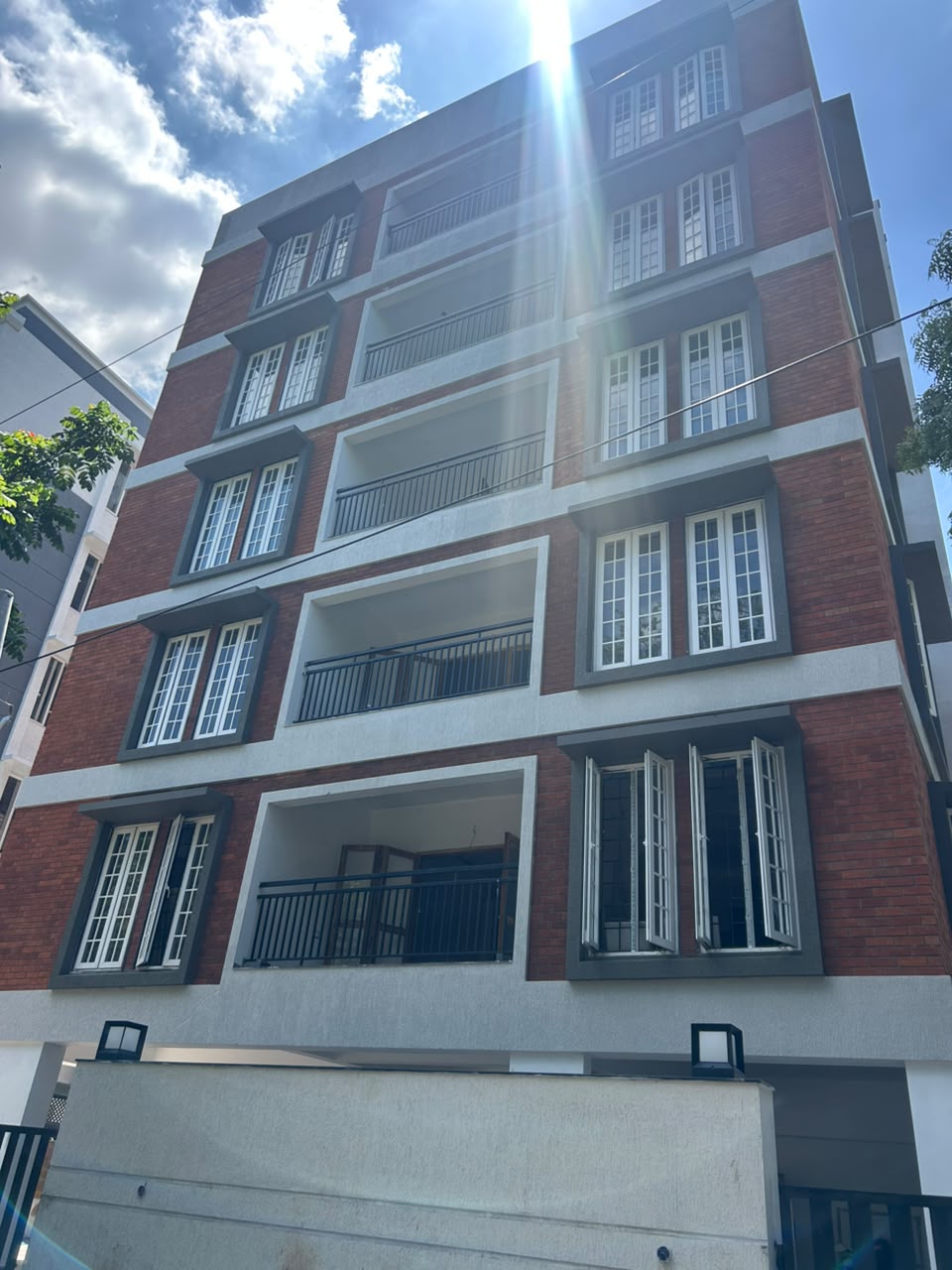

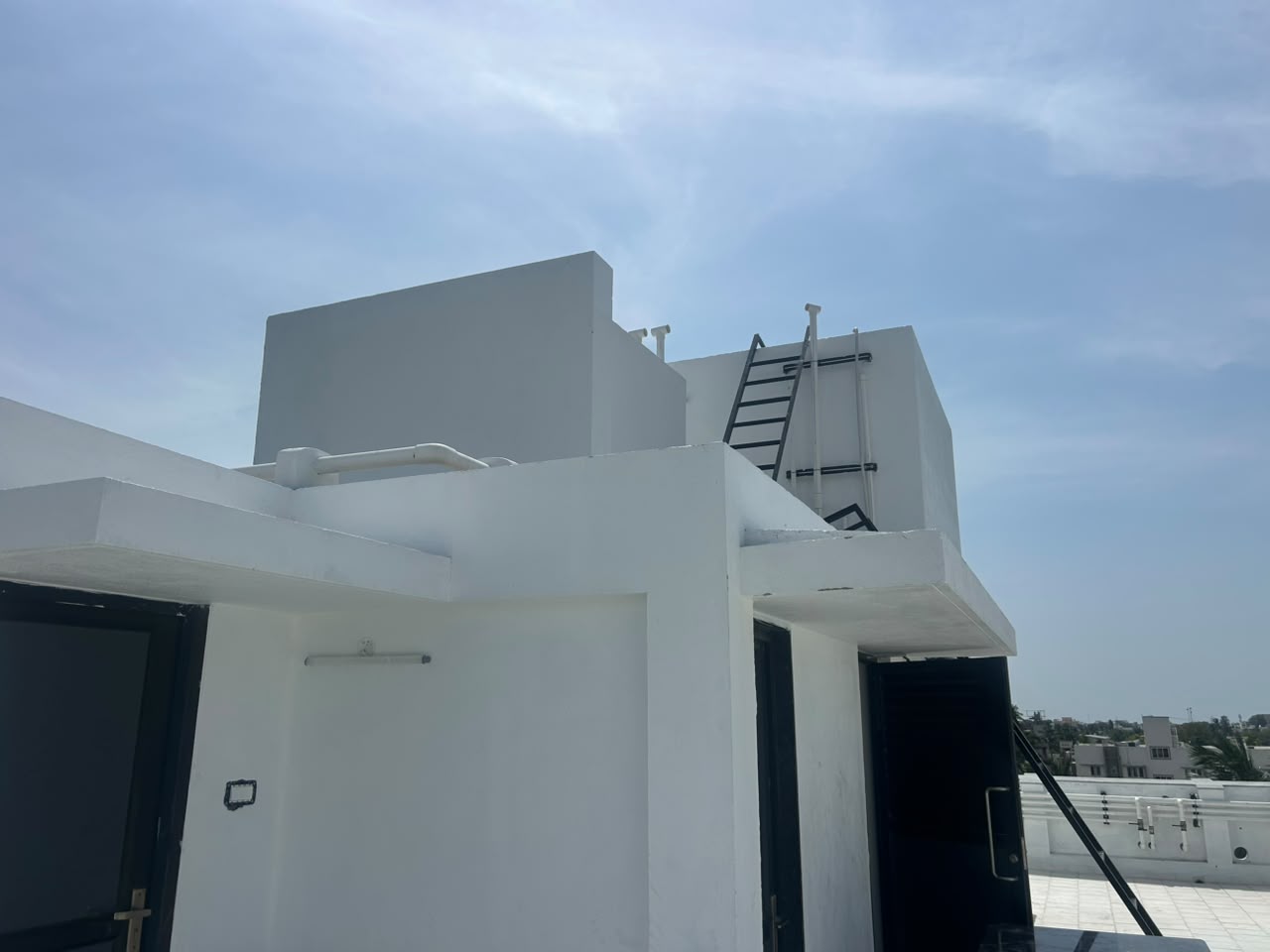

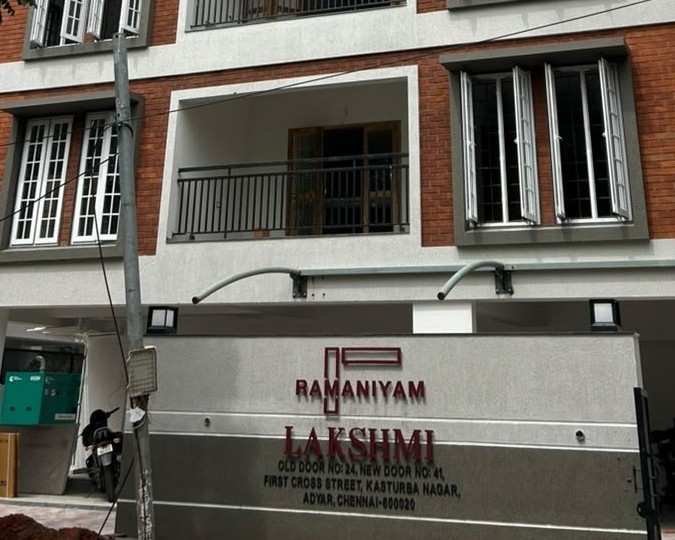

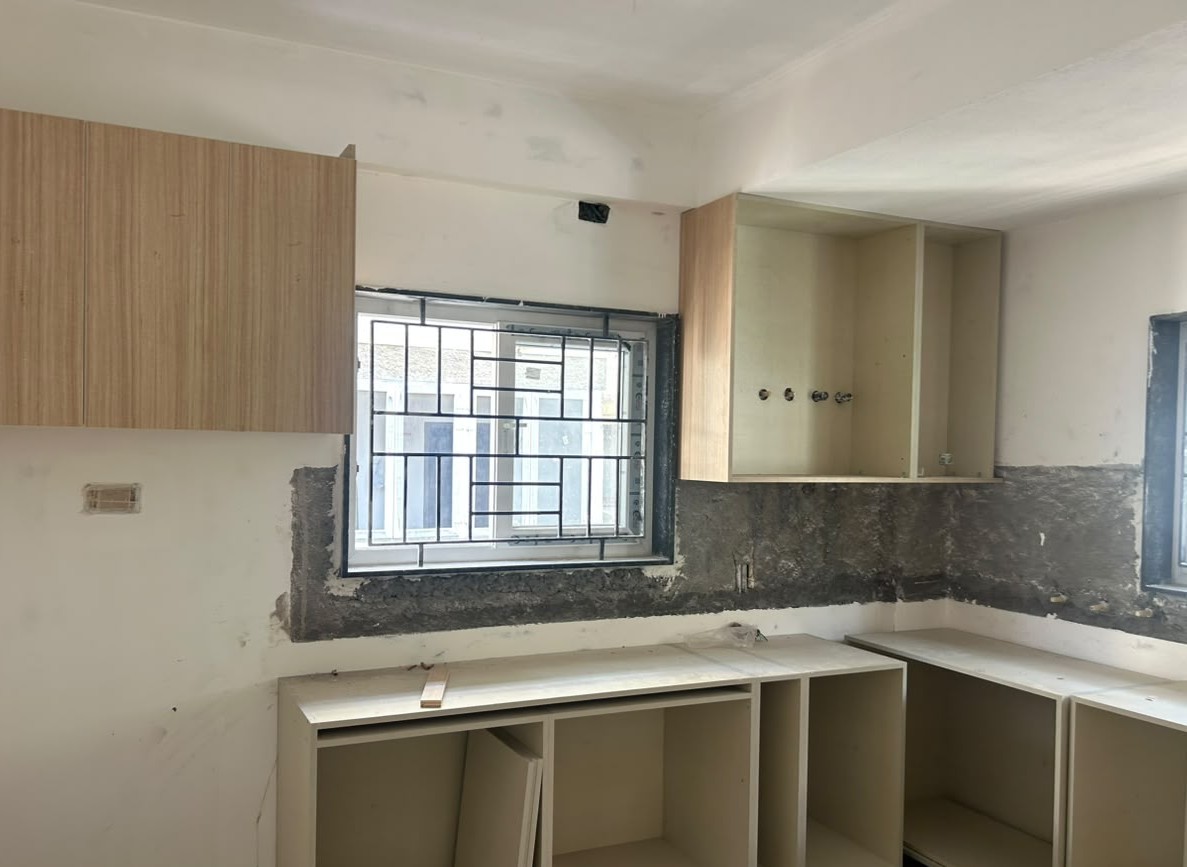

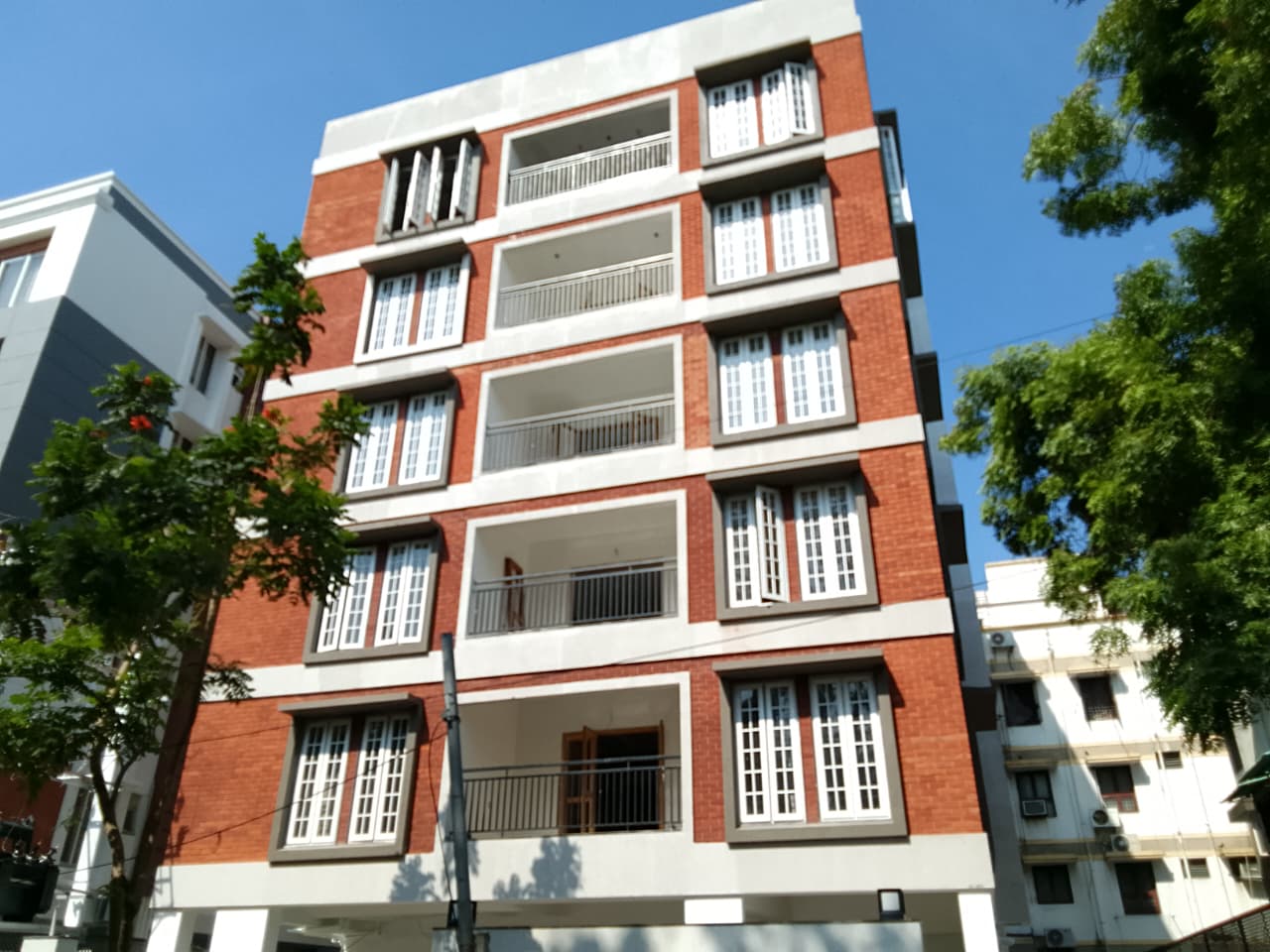

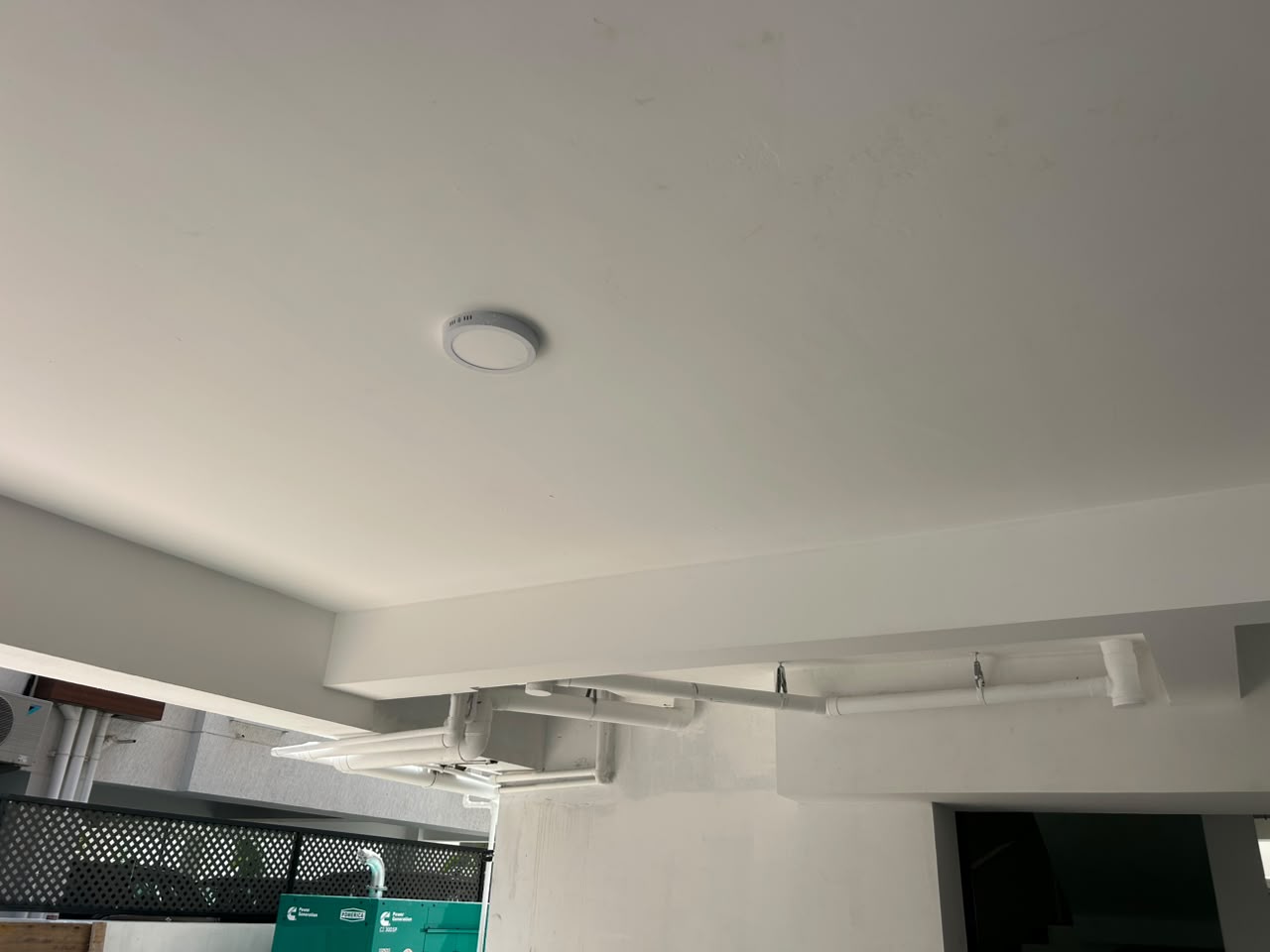

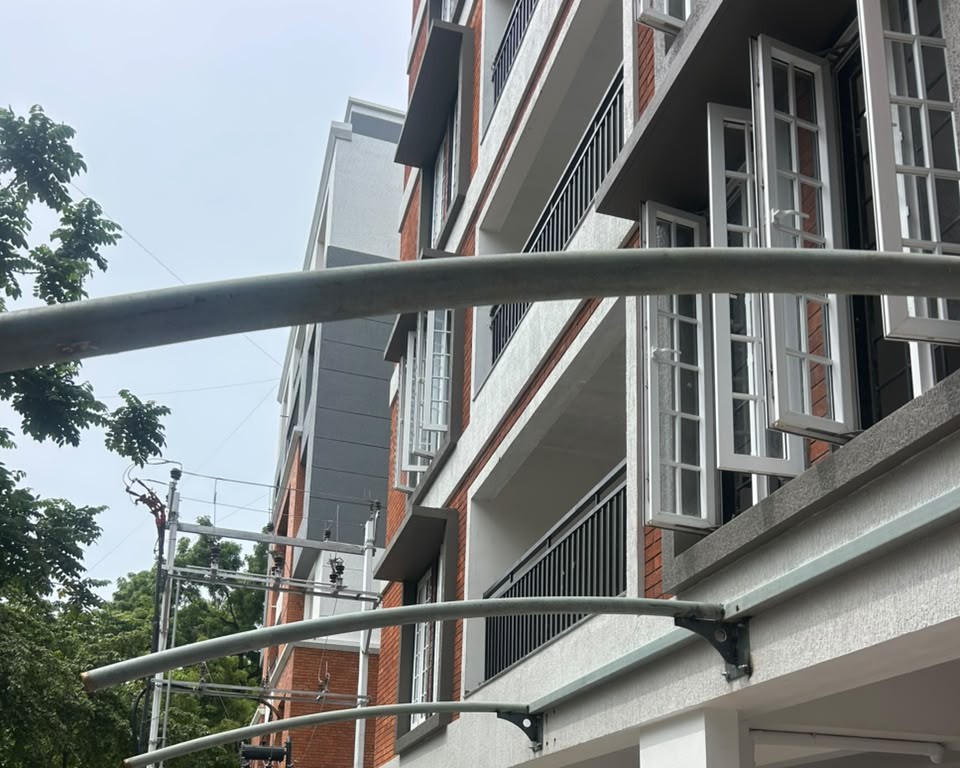

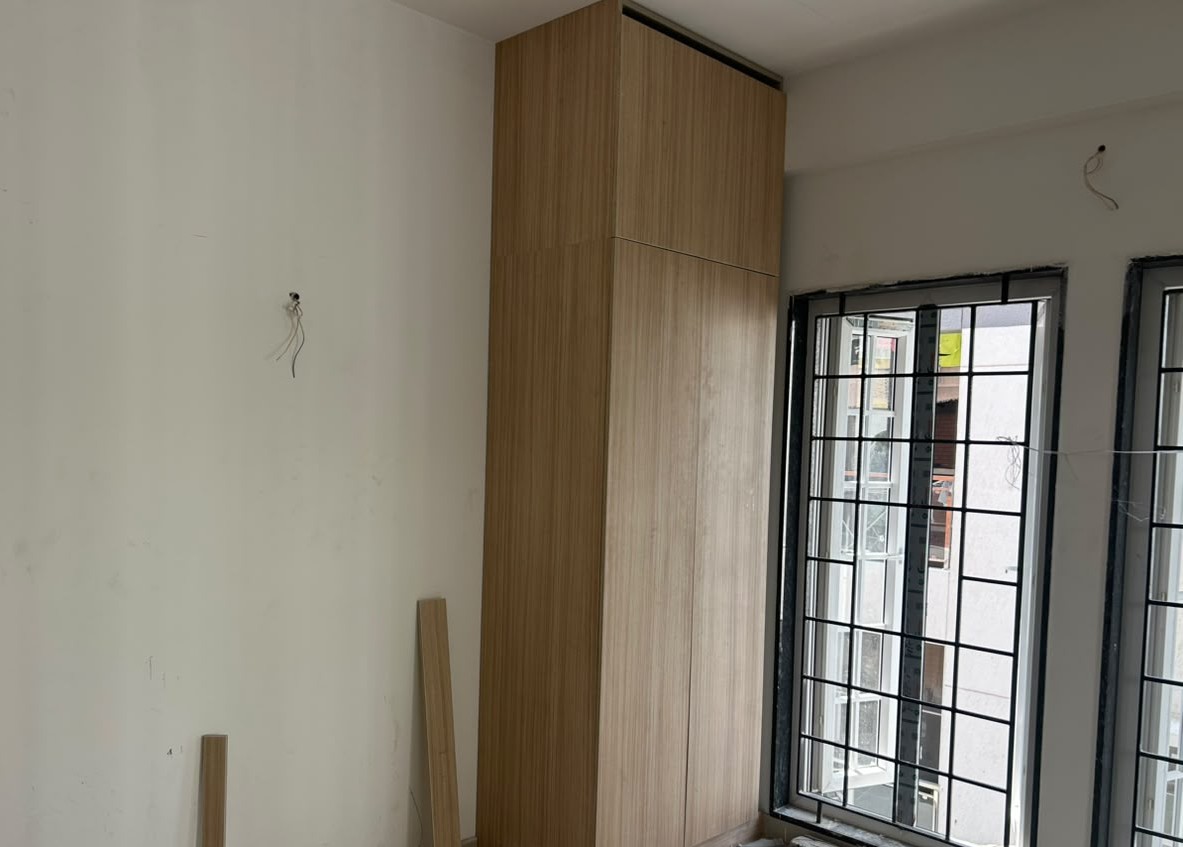

Project Update Images

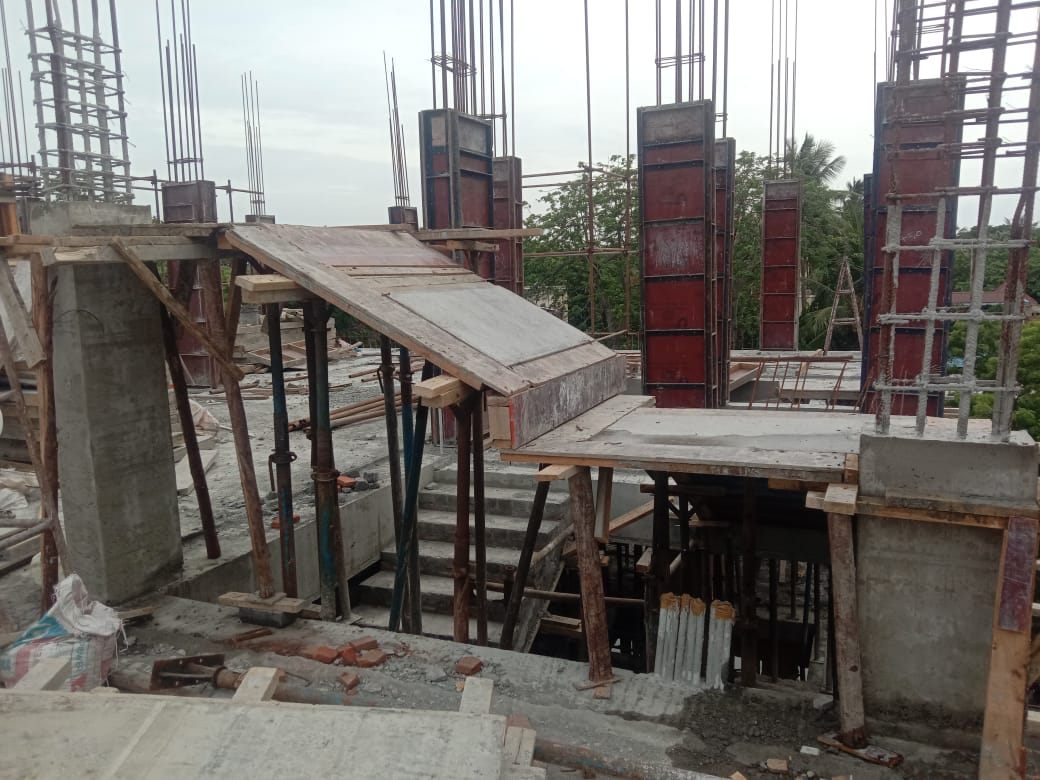

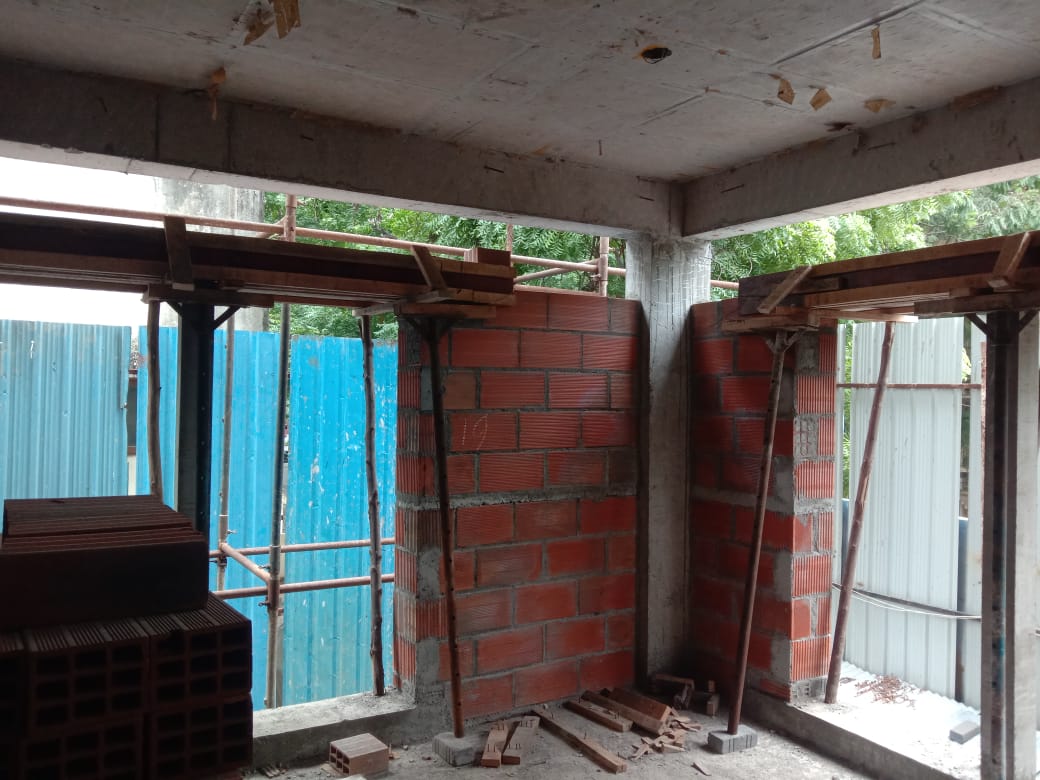

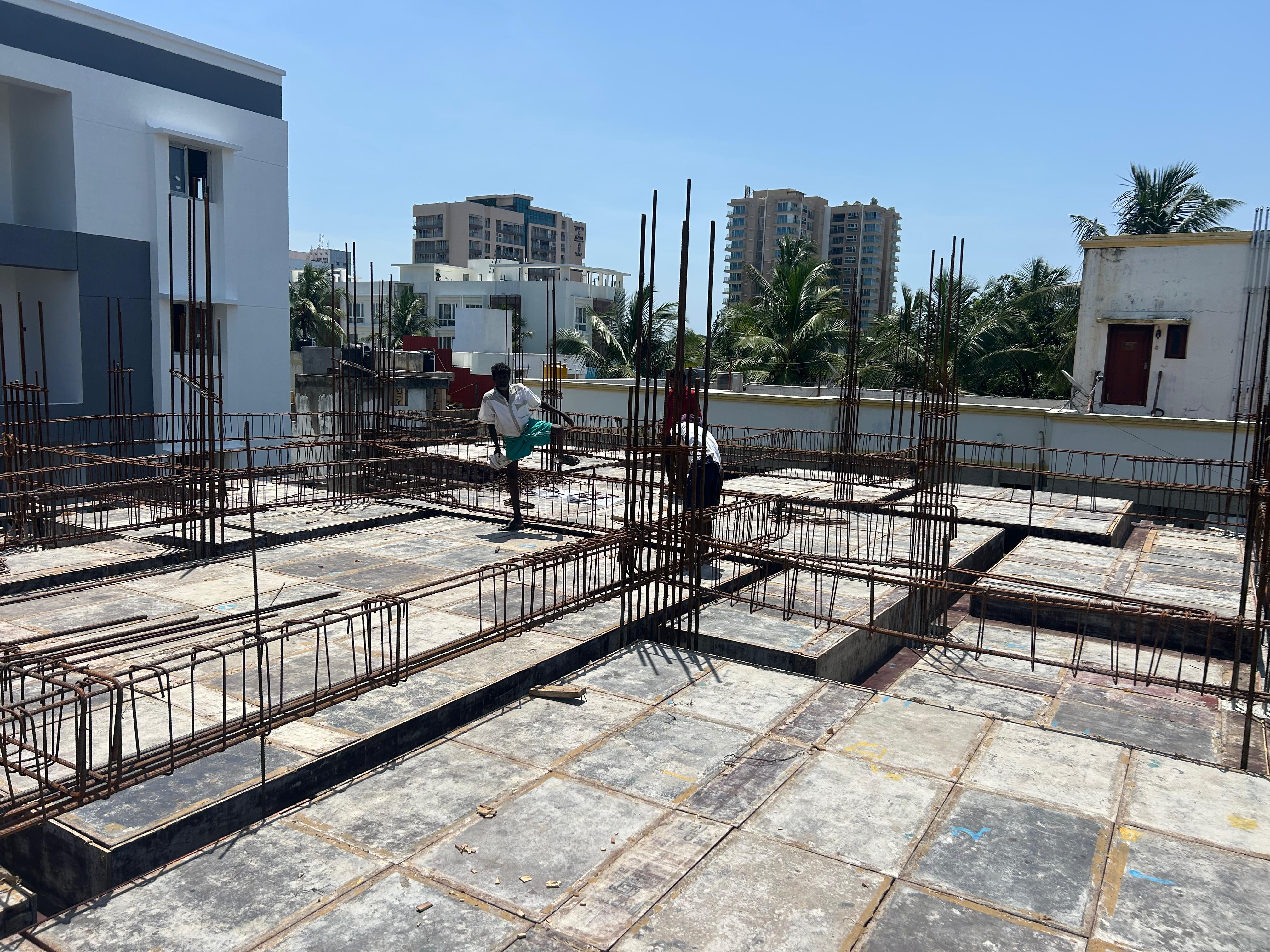

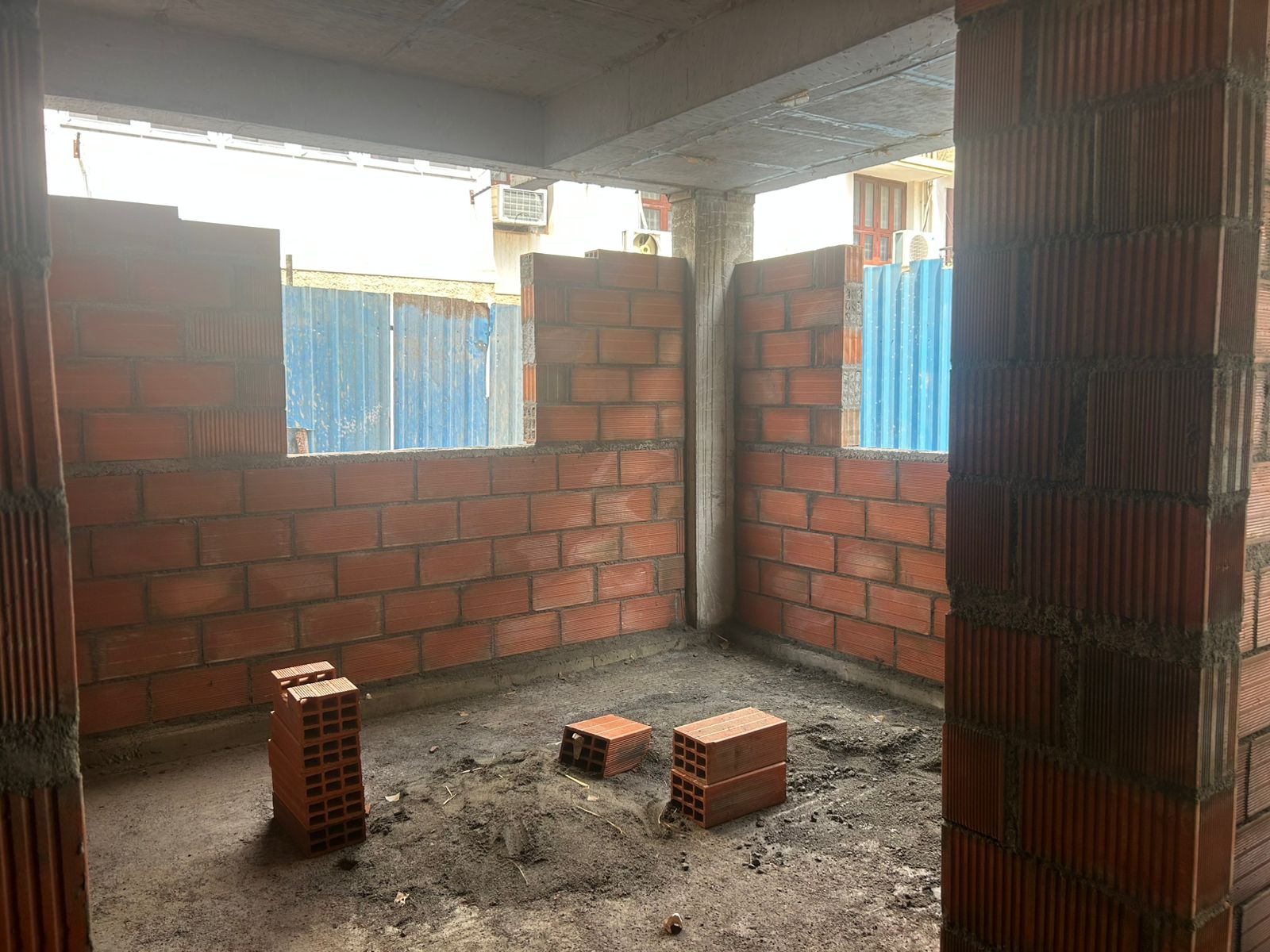

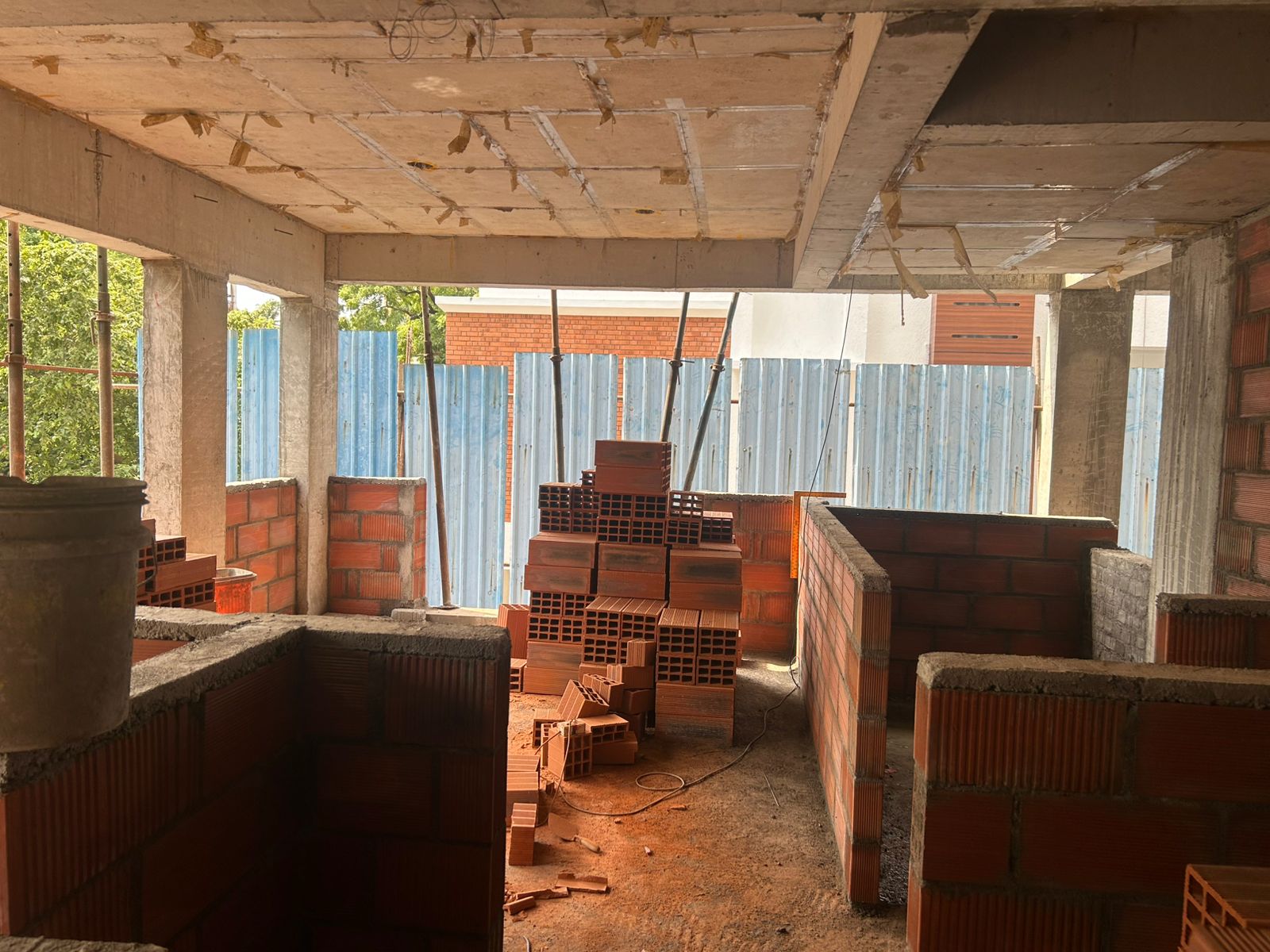

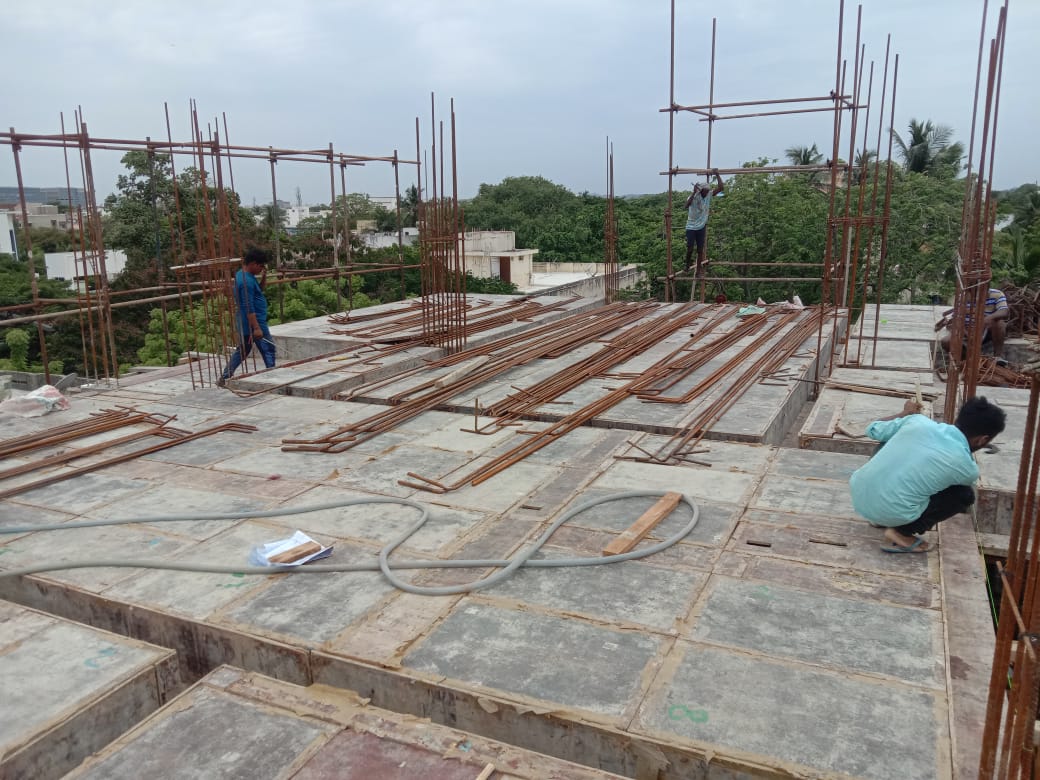

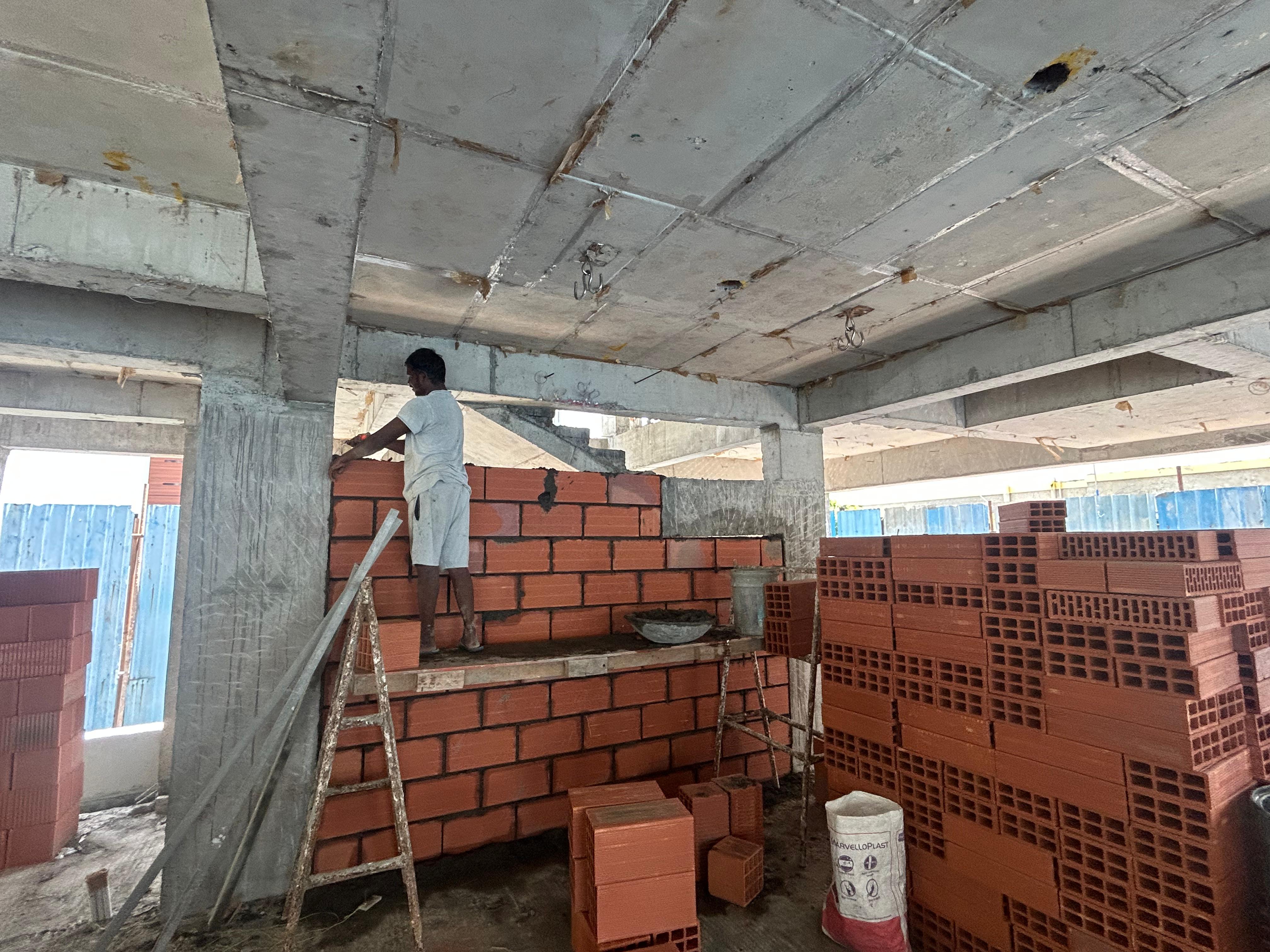

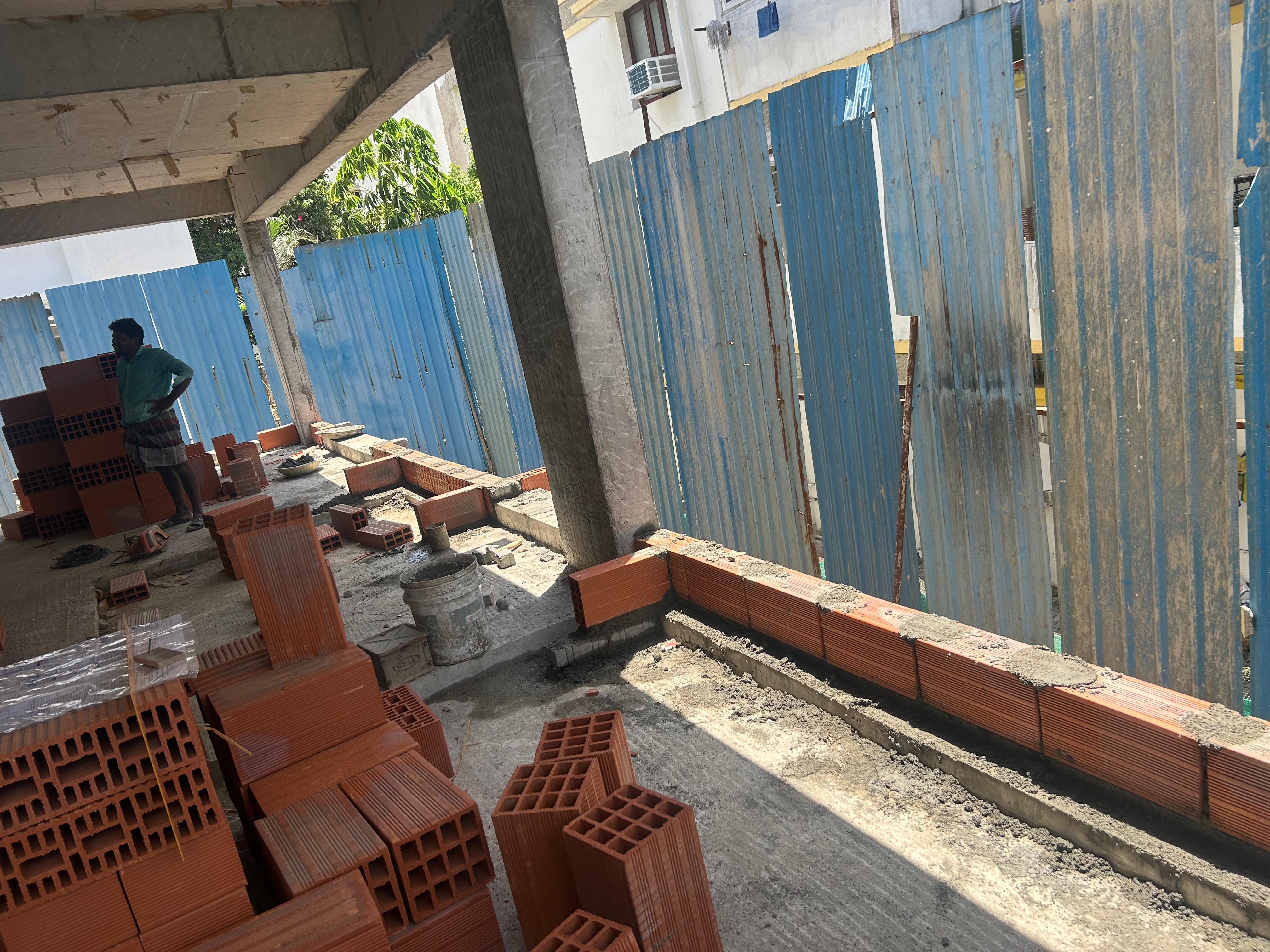

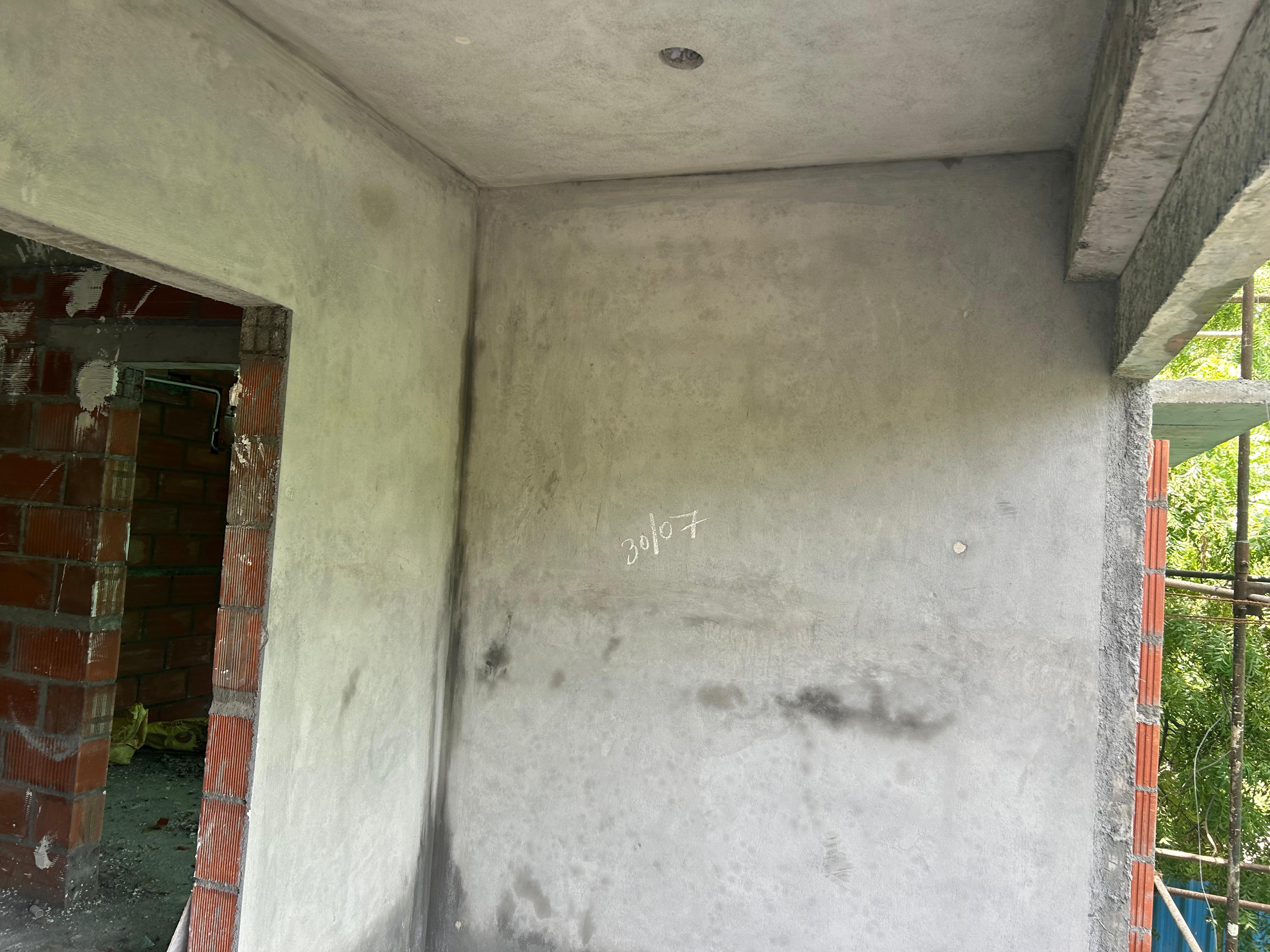

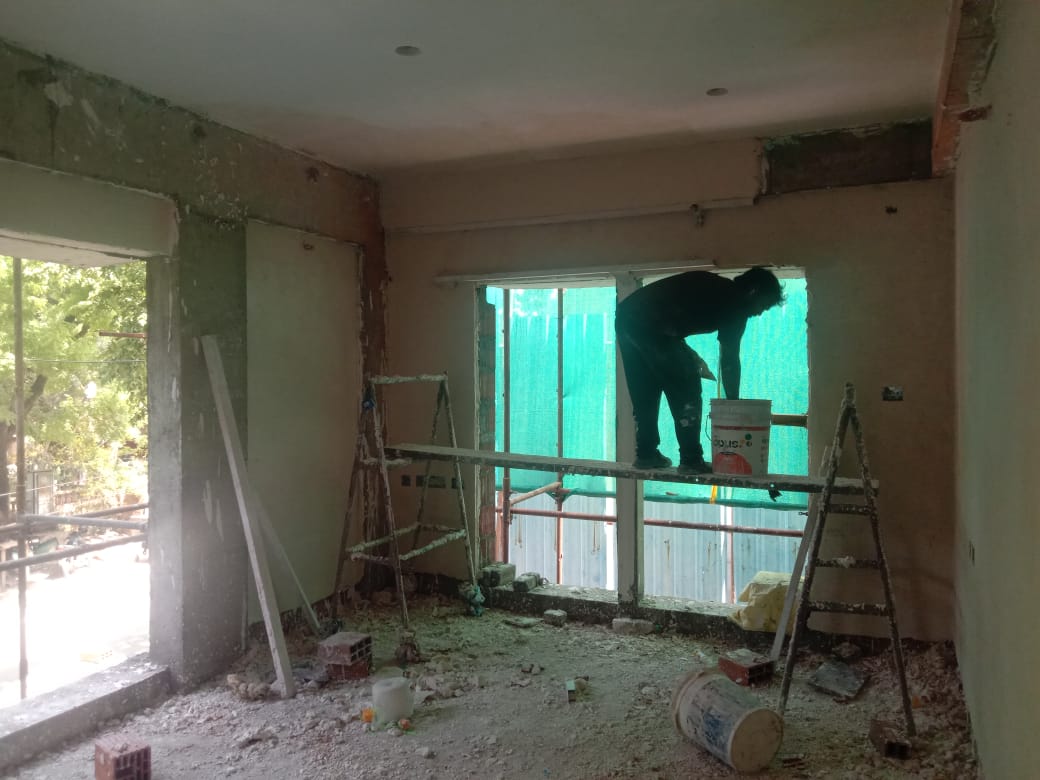

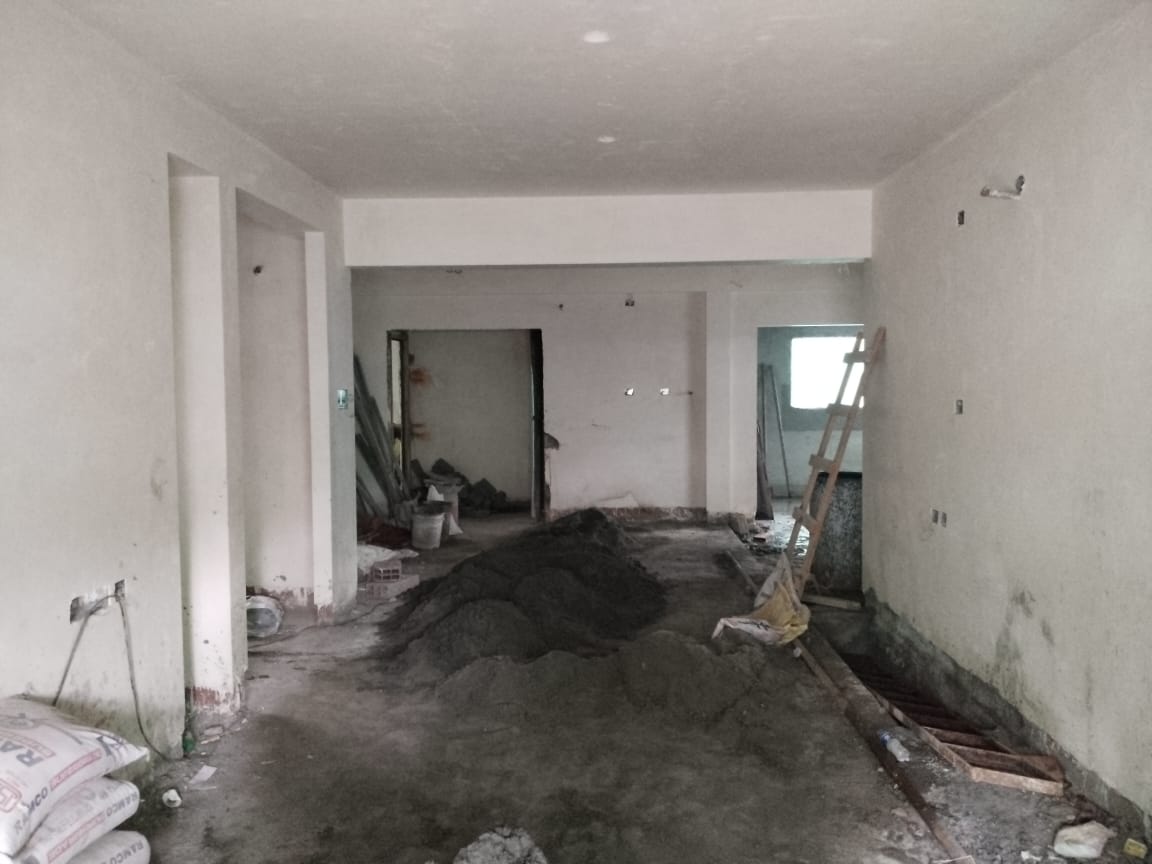

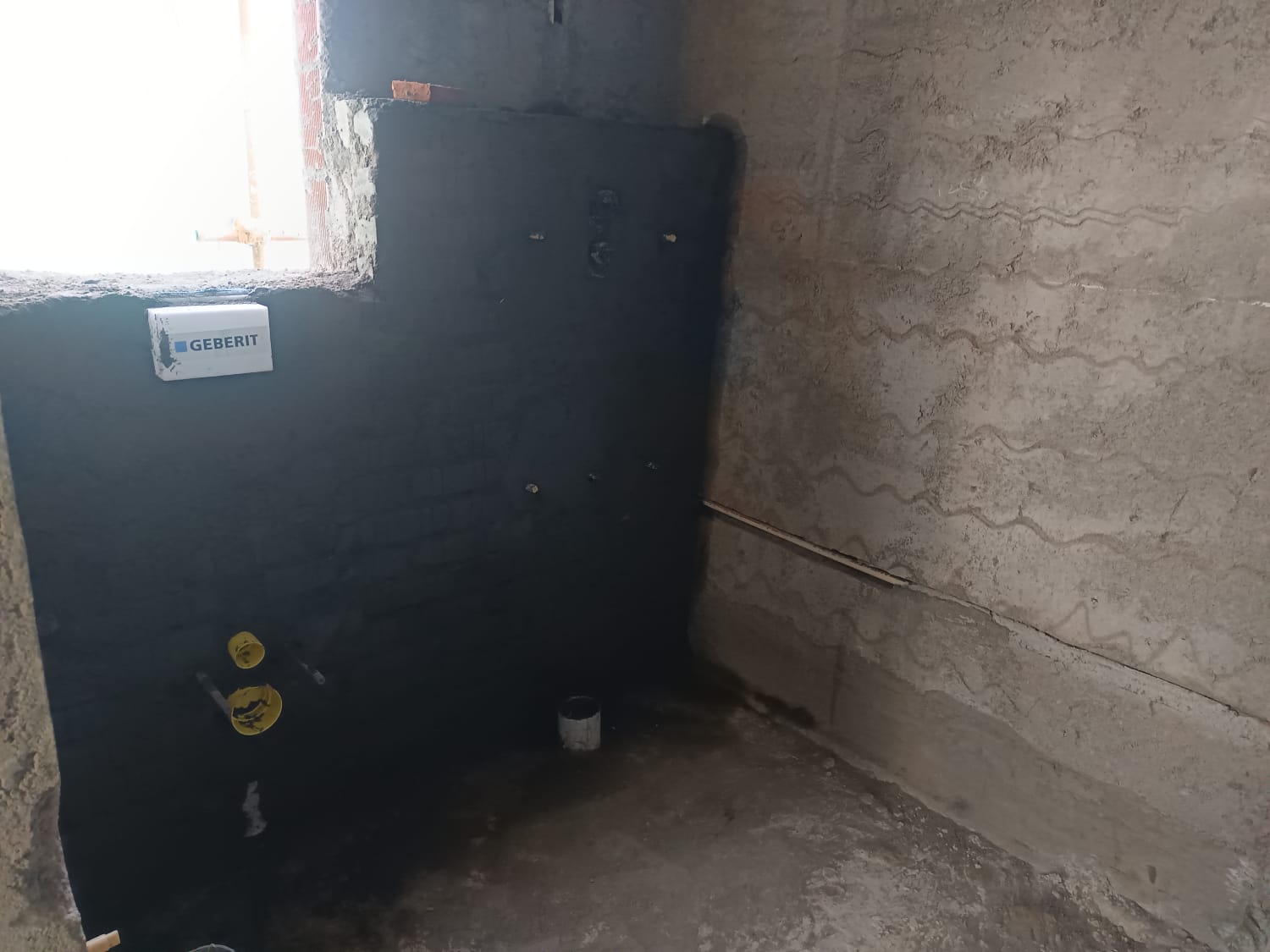

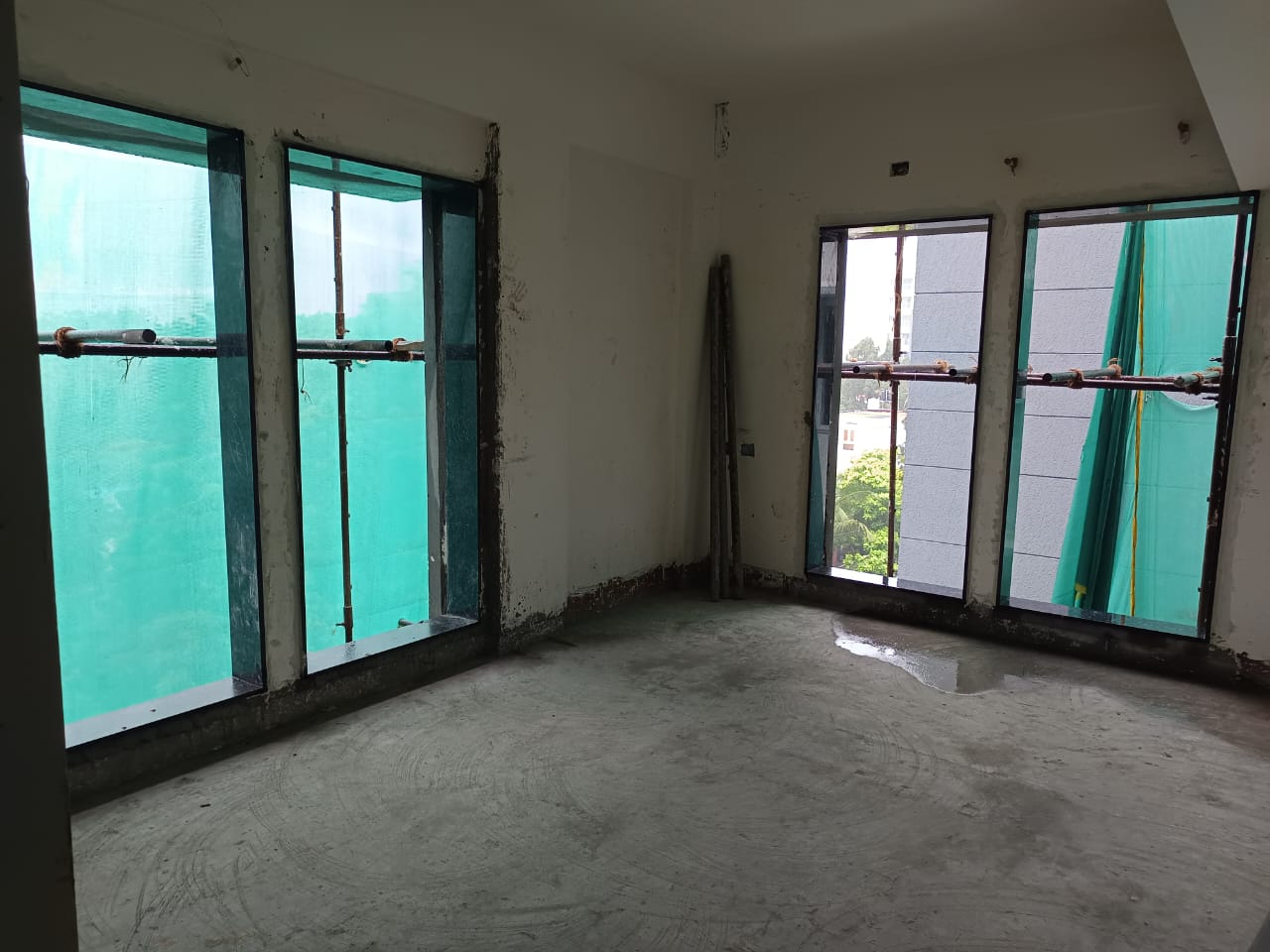

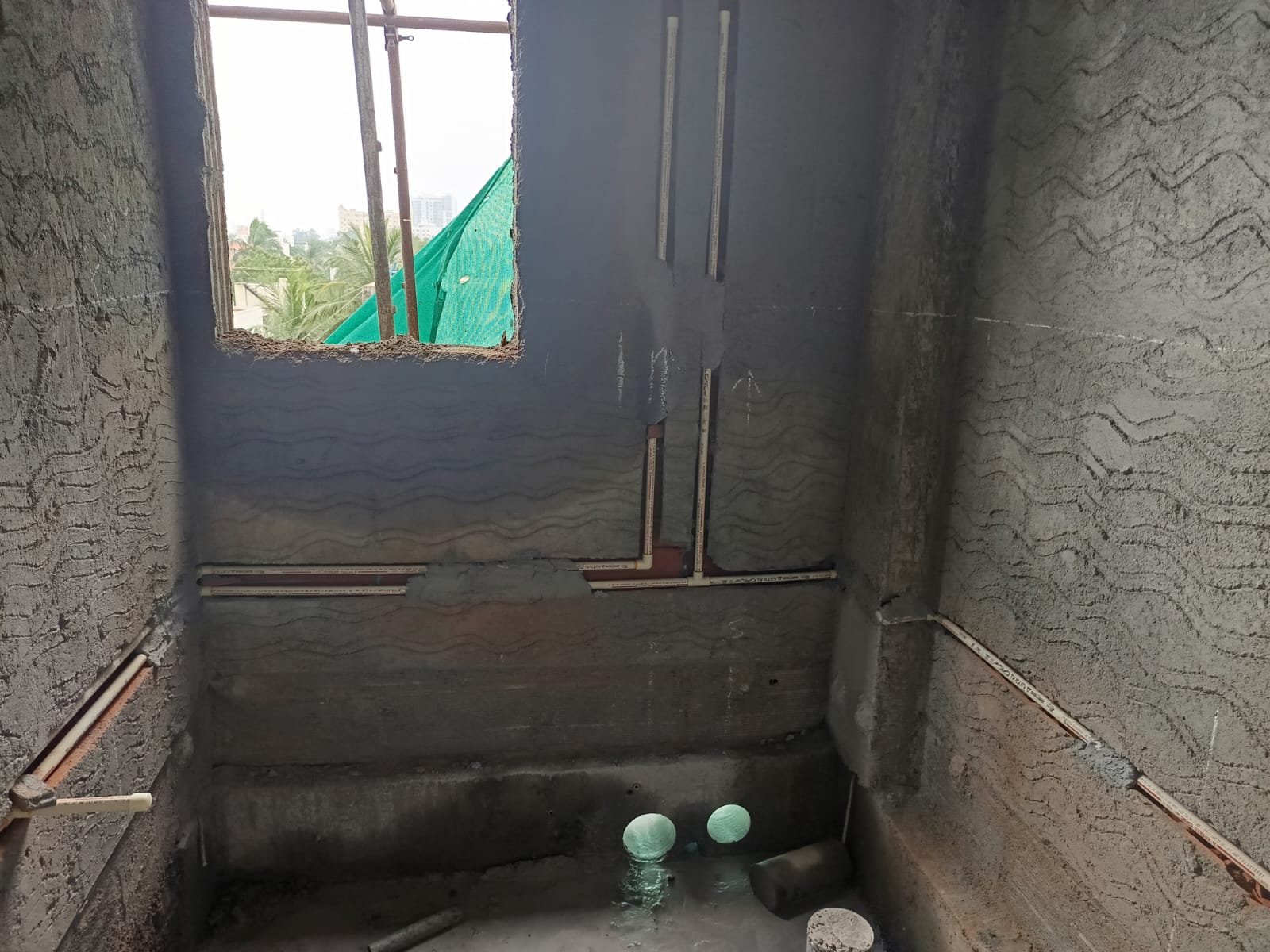

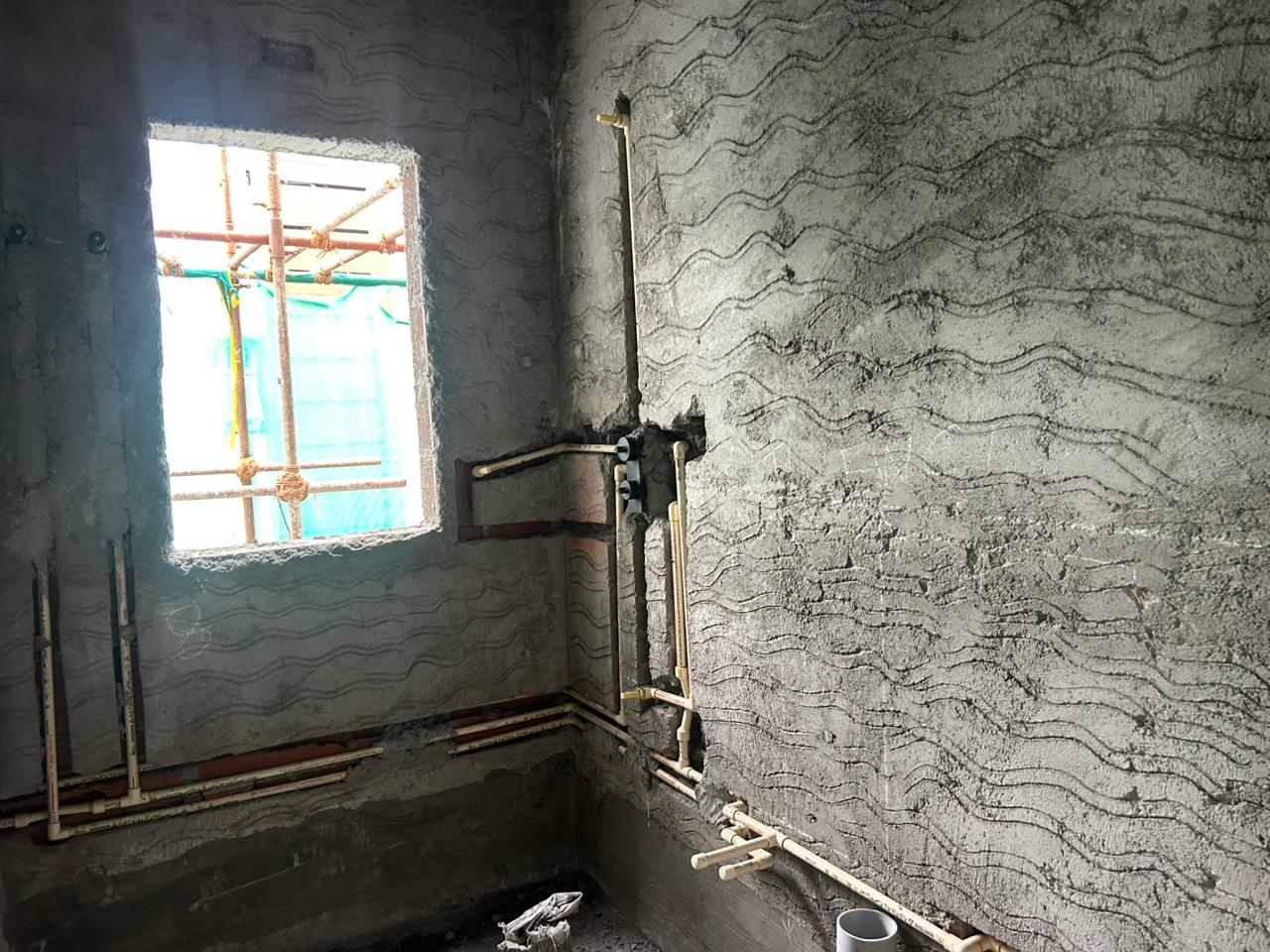

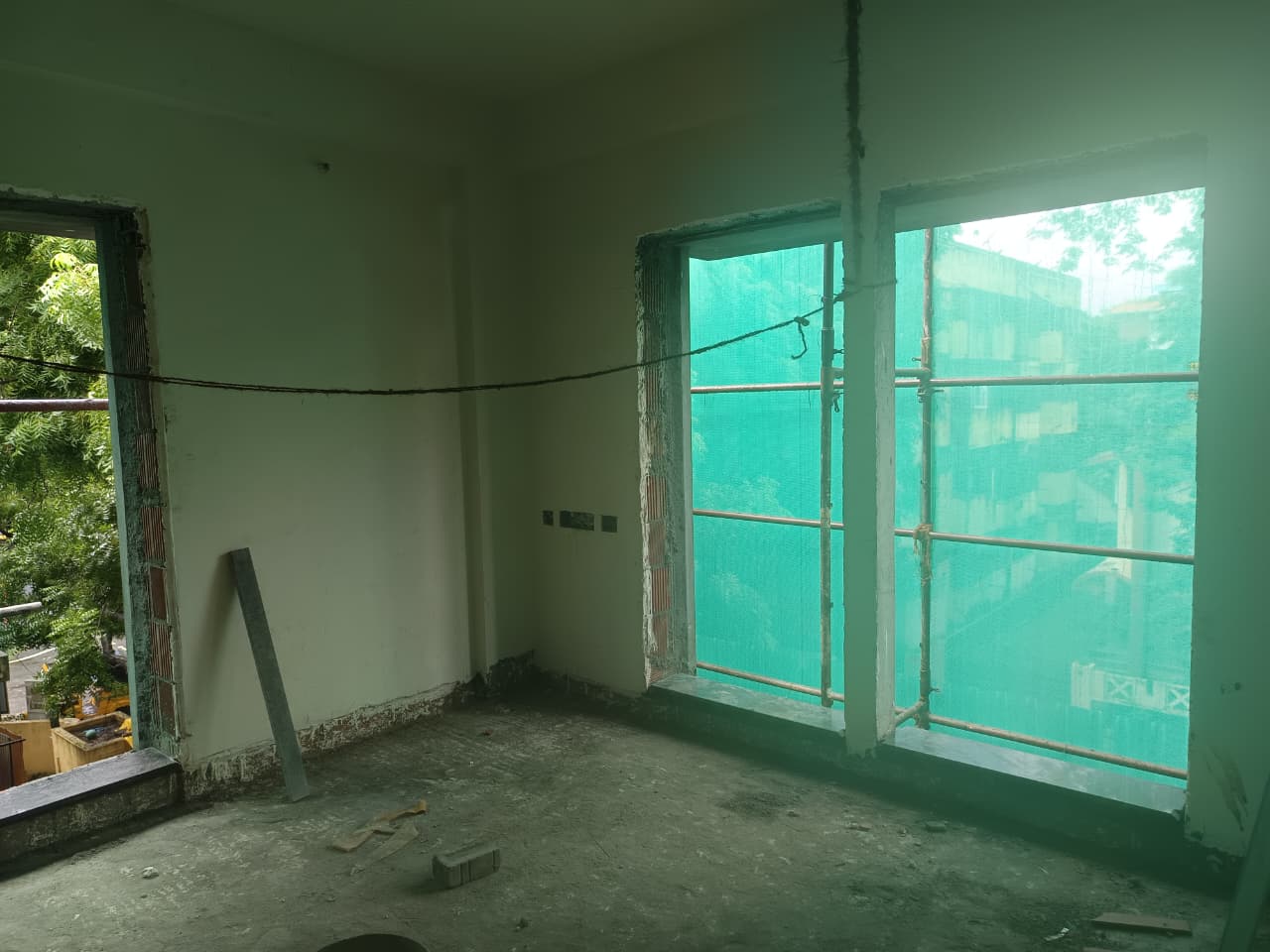

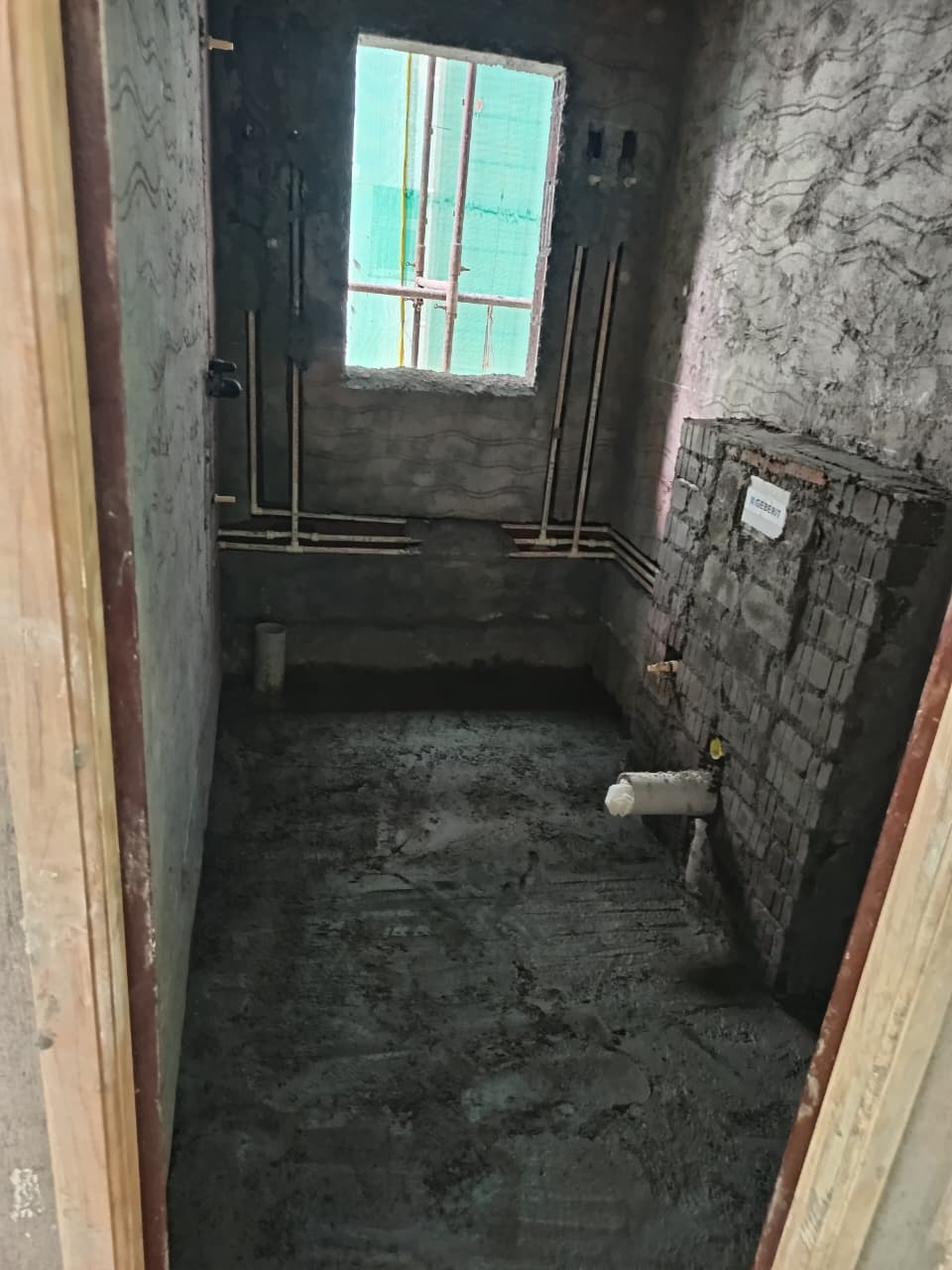

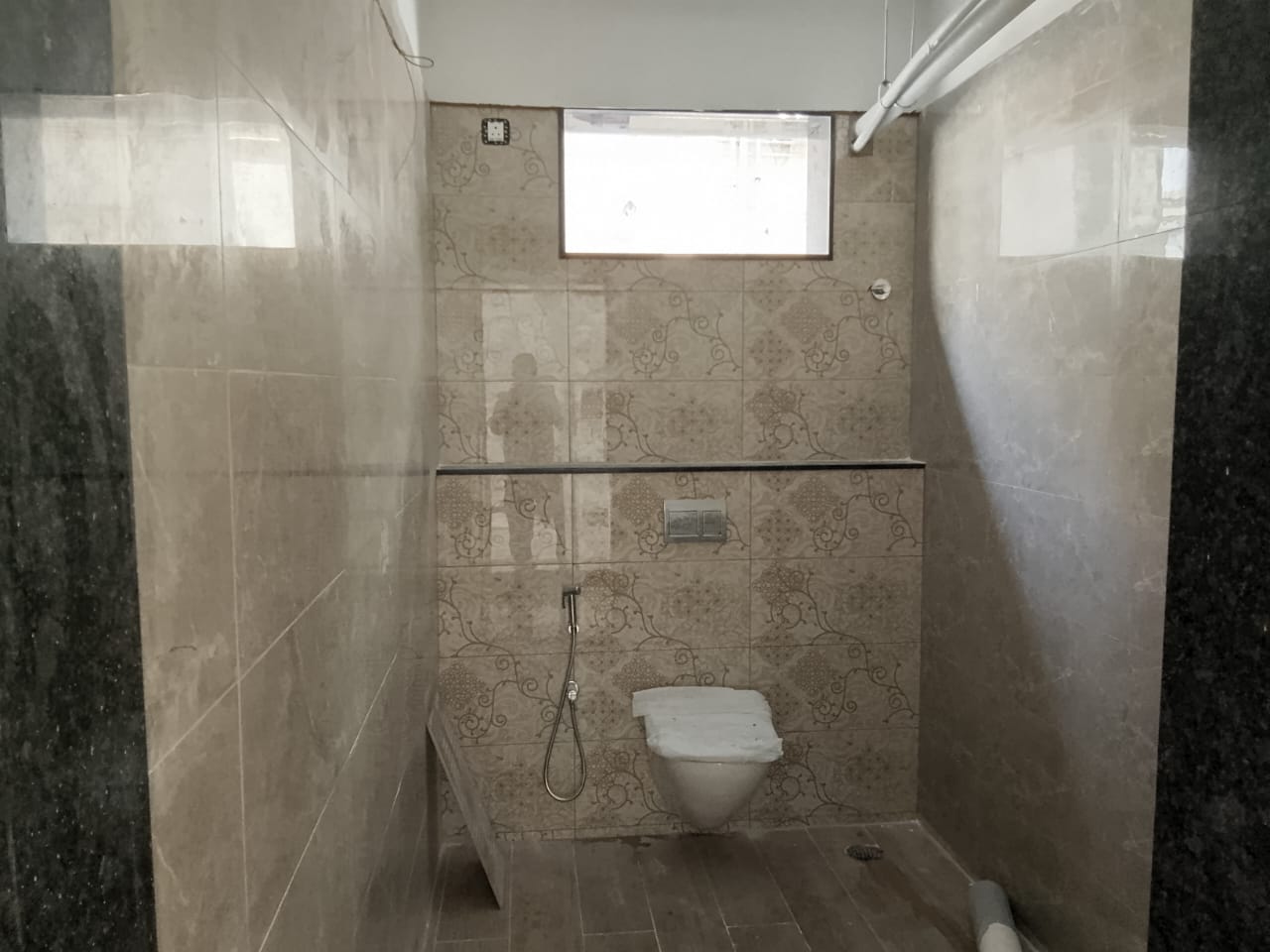

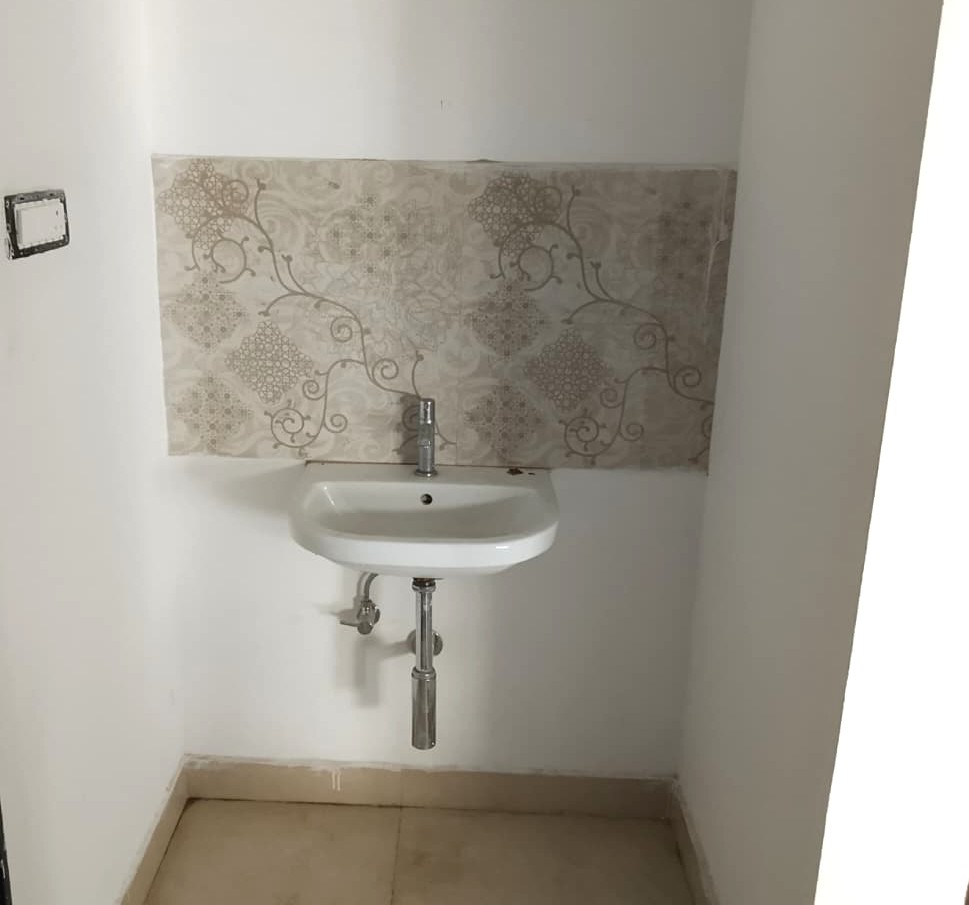

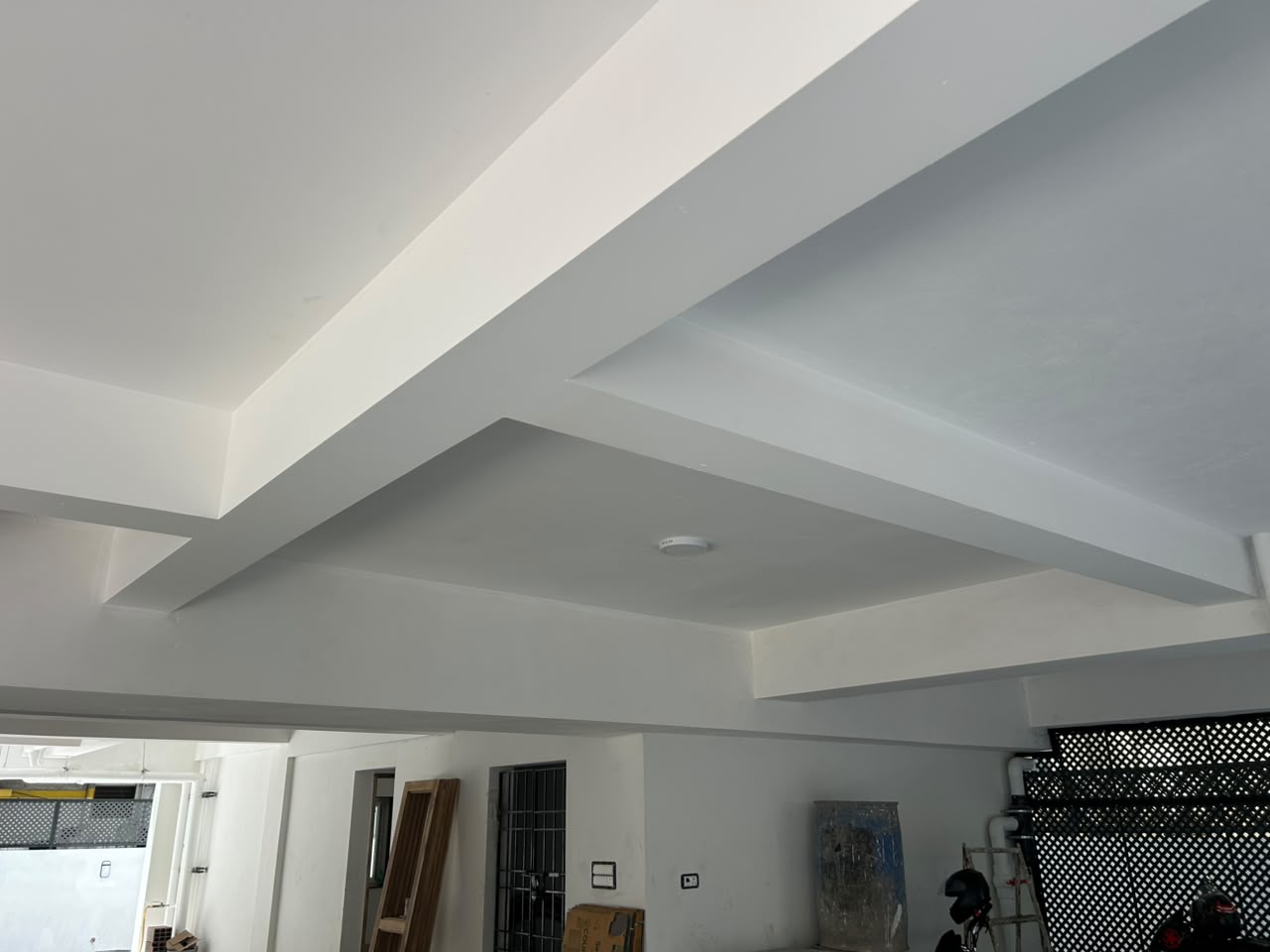

  • All floor toilet plumbing work is Completed.

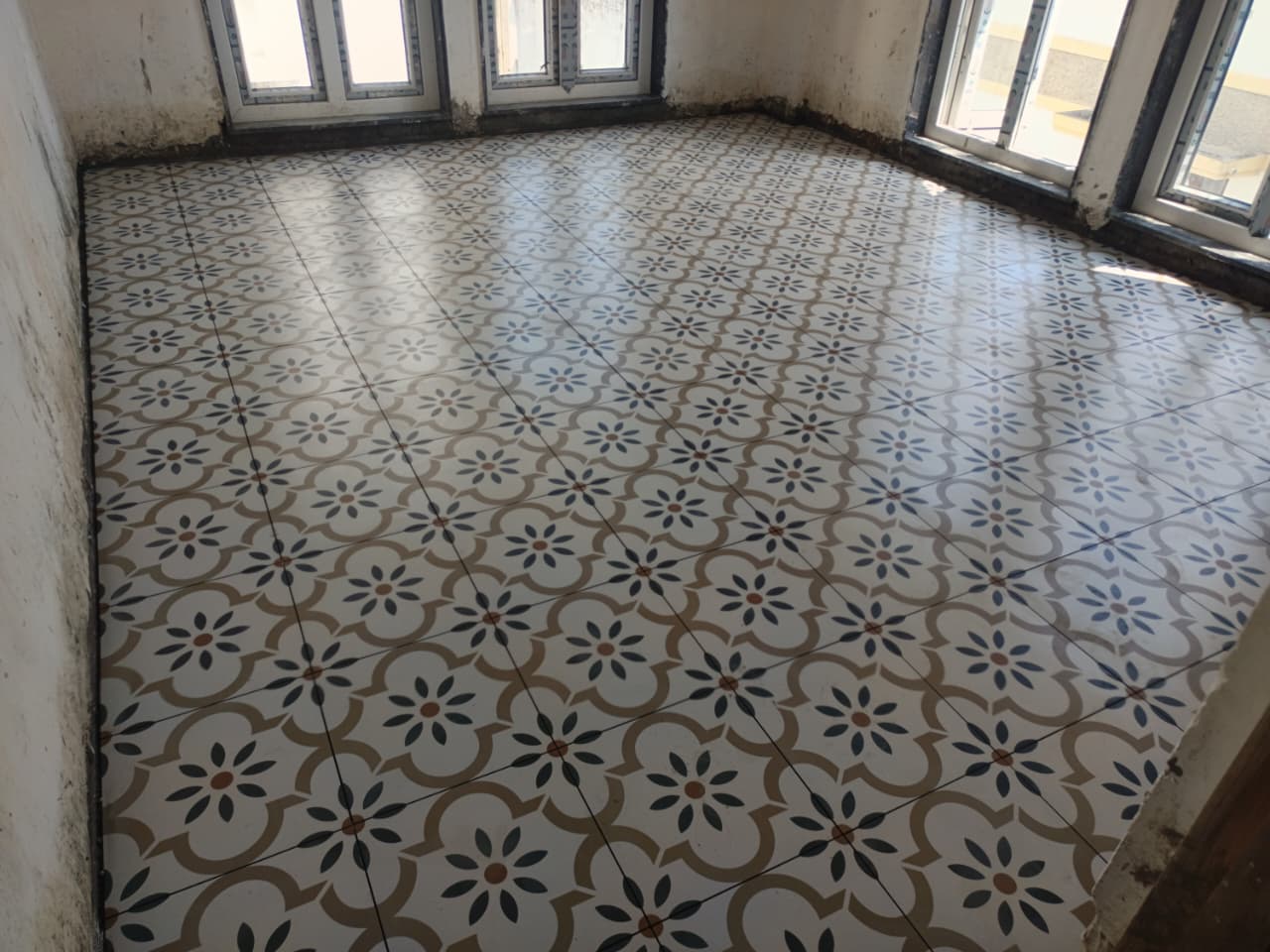

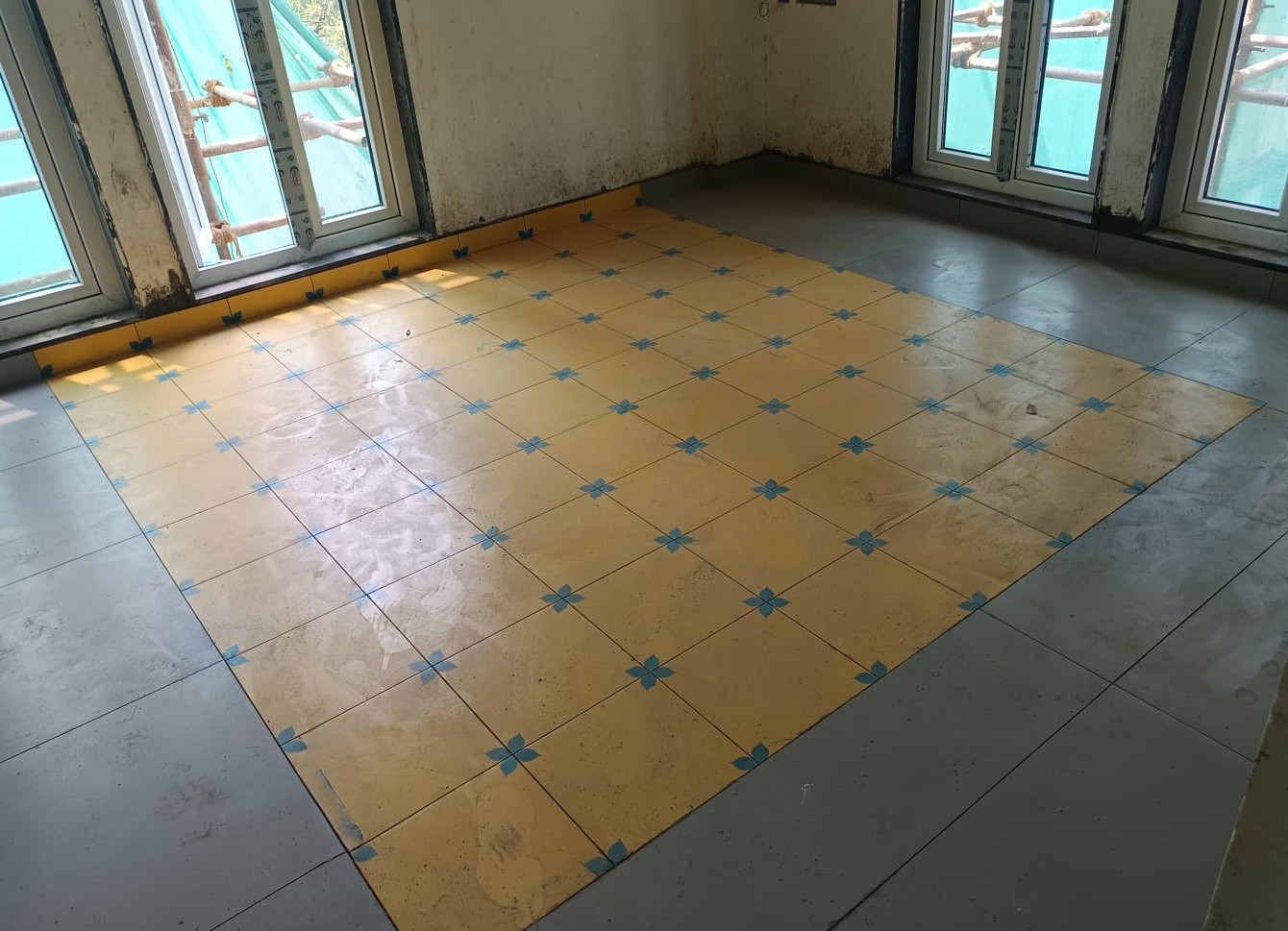

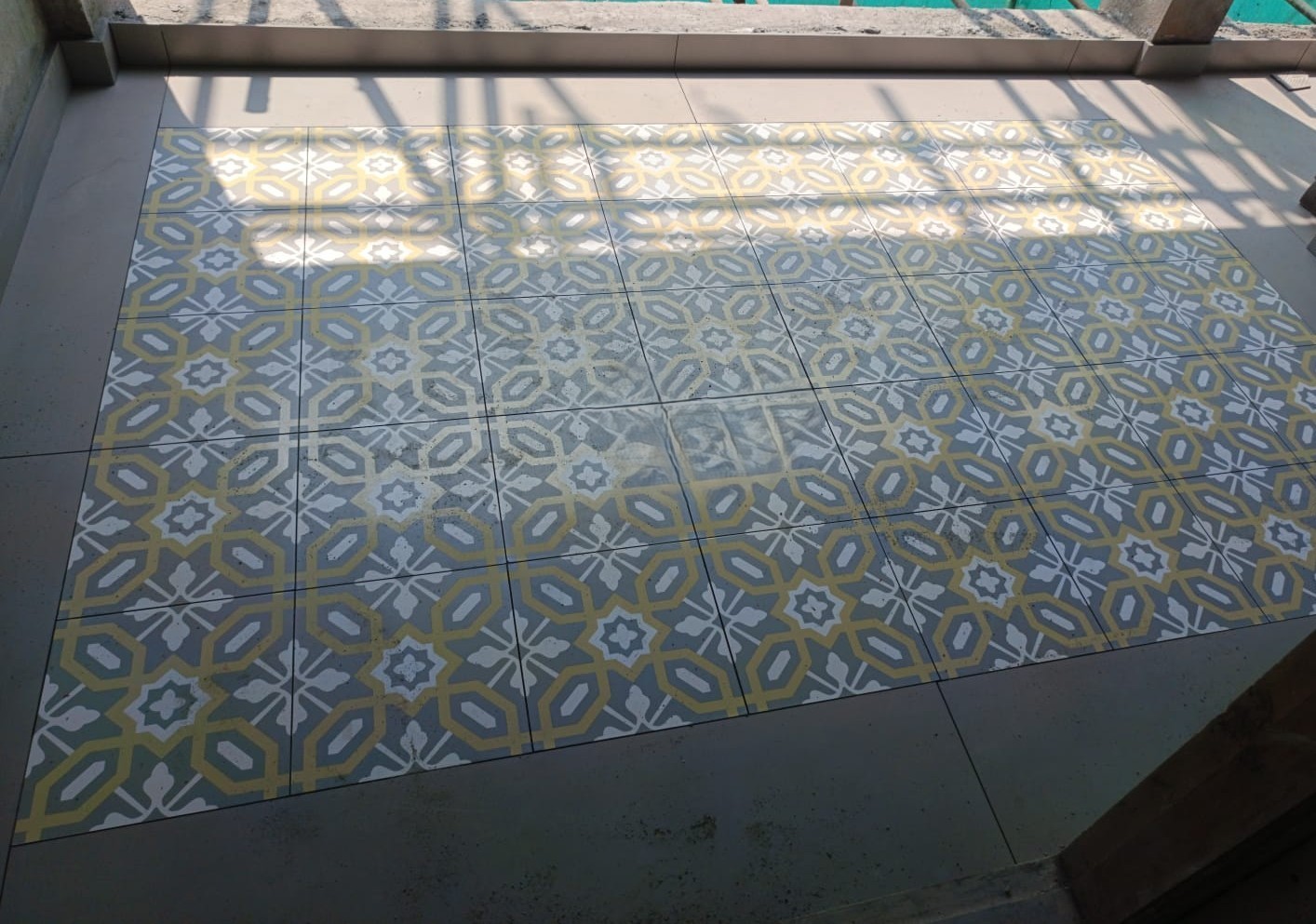

  • General flooring work is completed.(1st and 2nd floor completed)

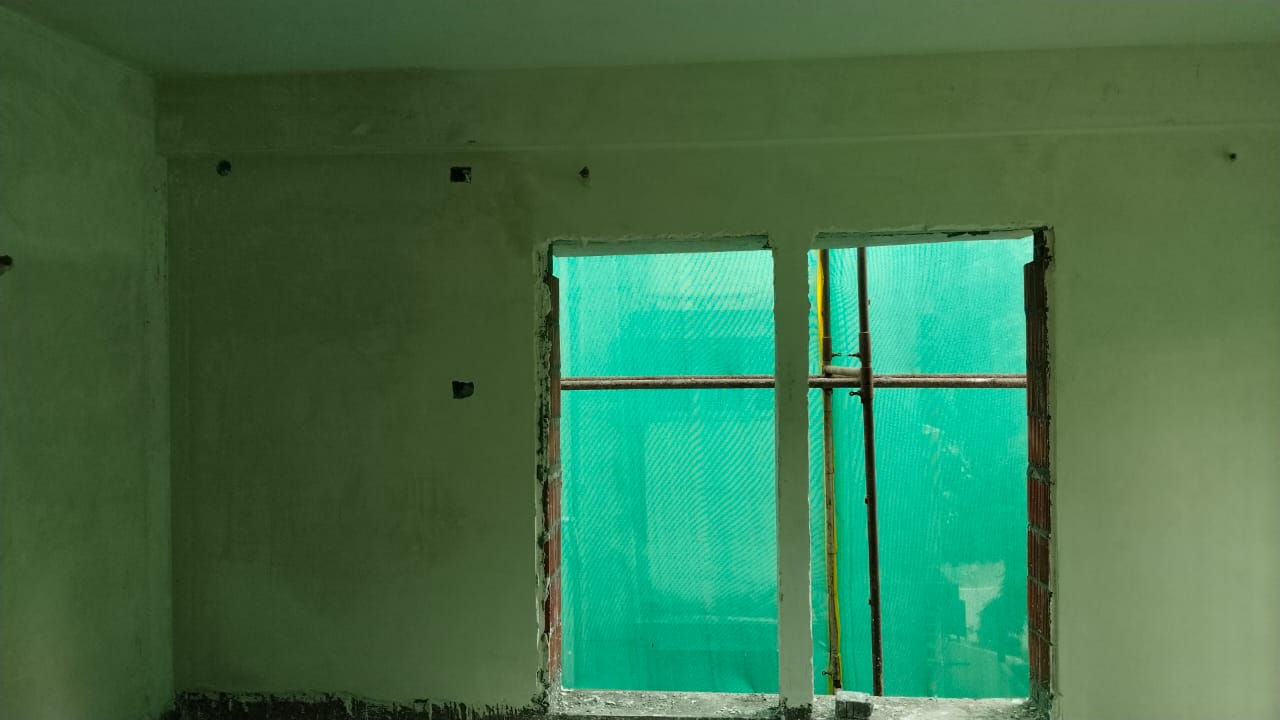

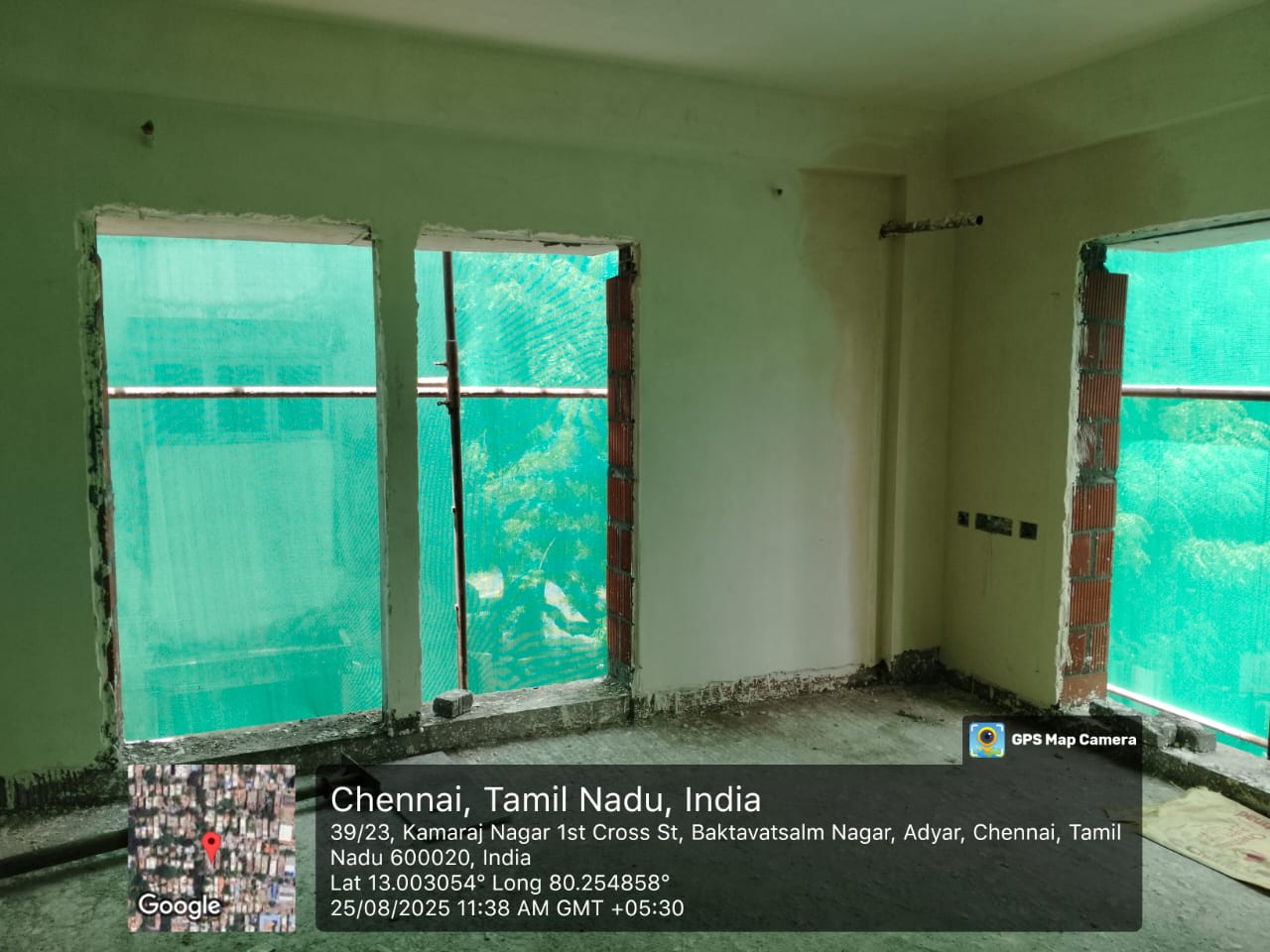

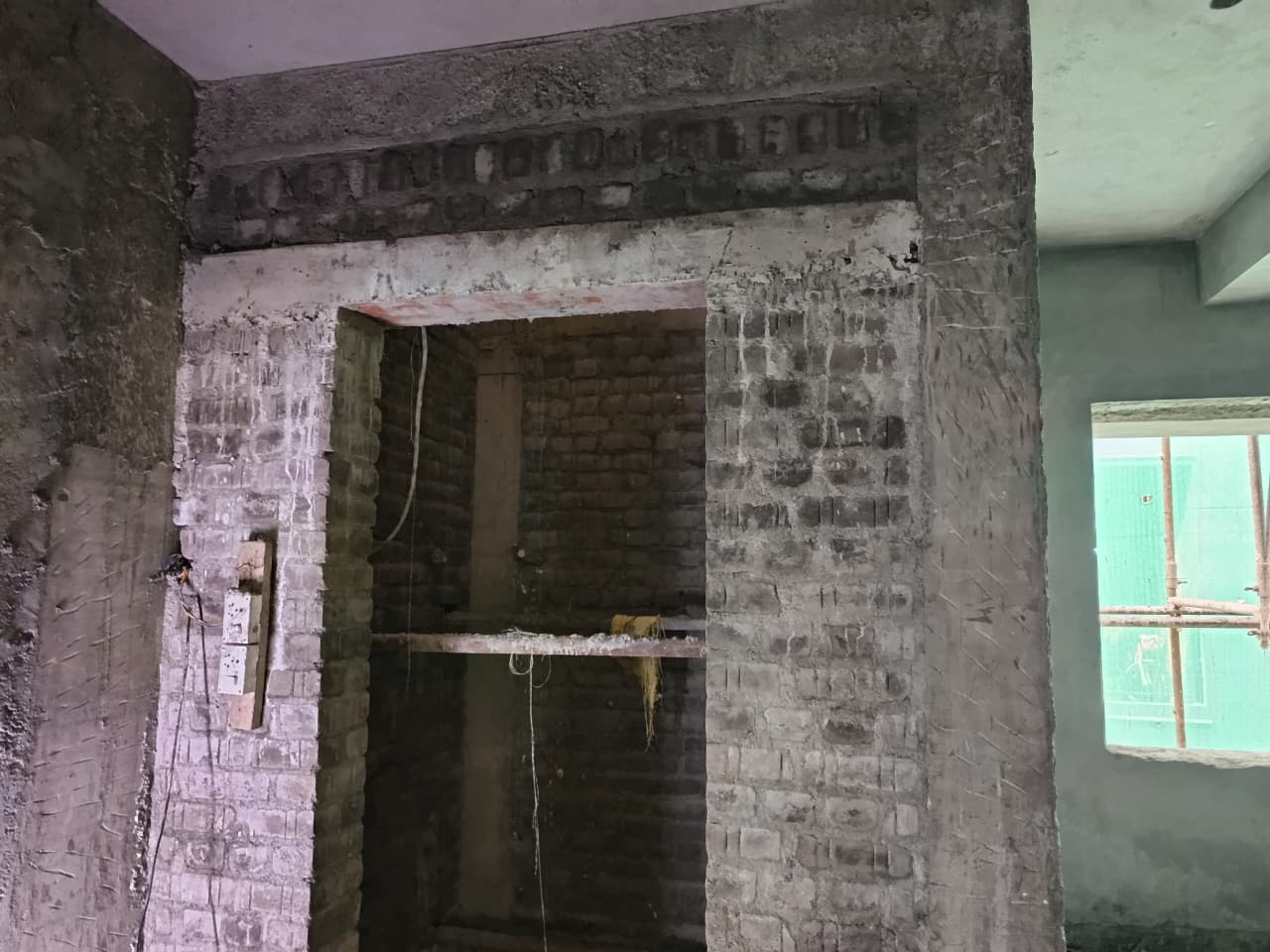

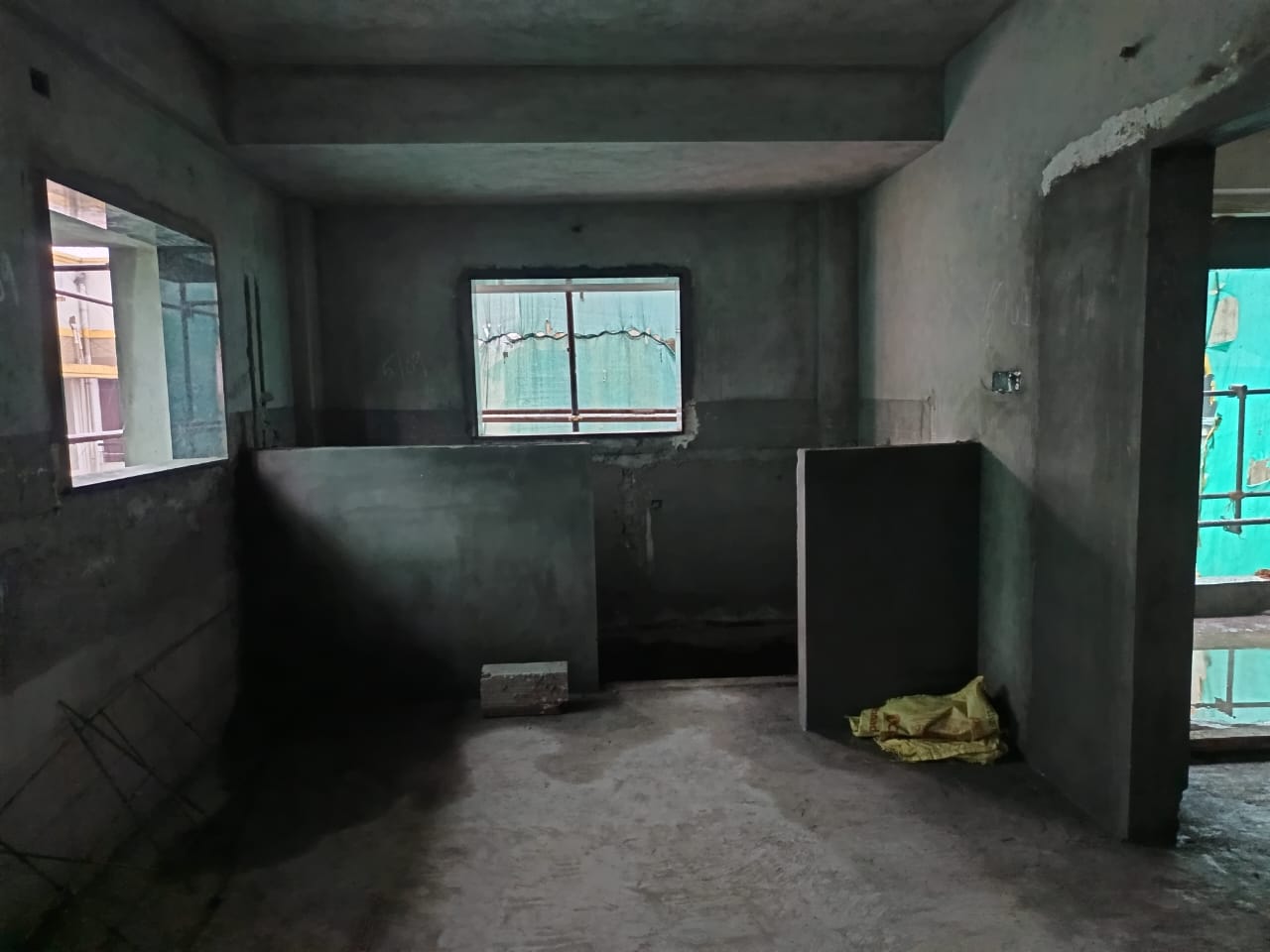

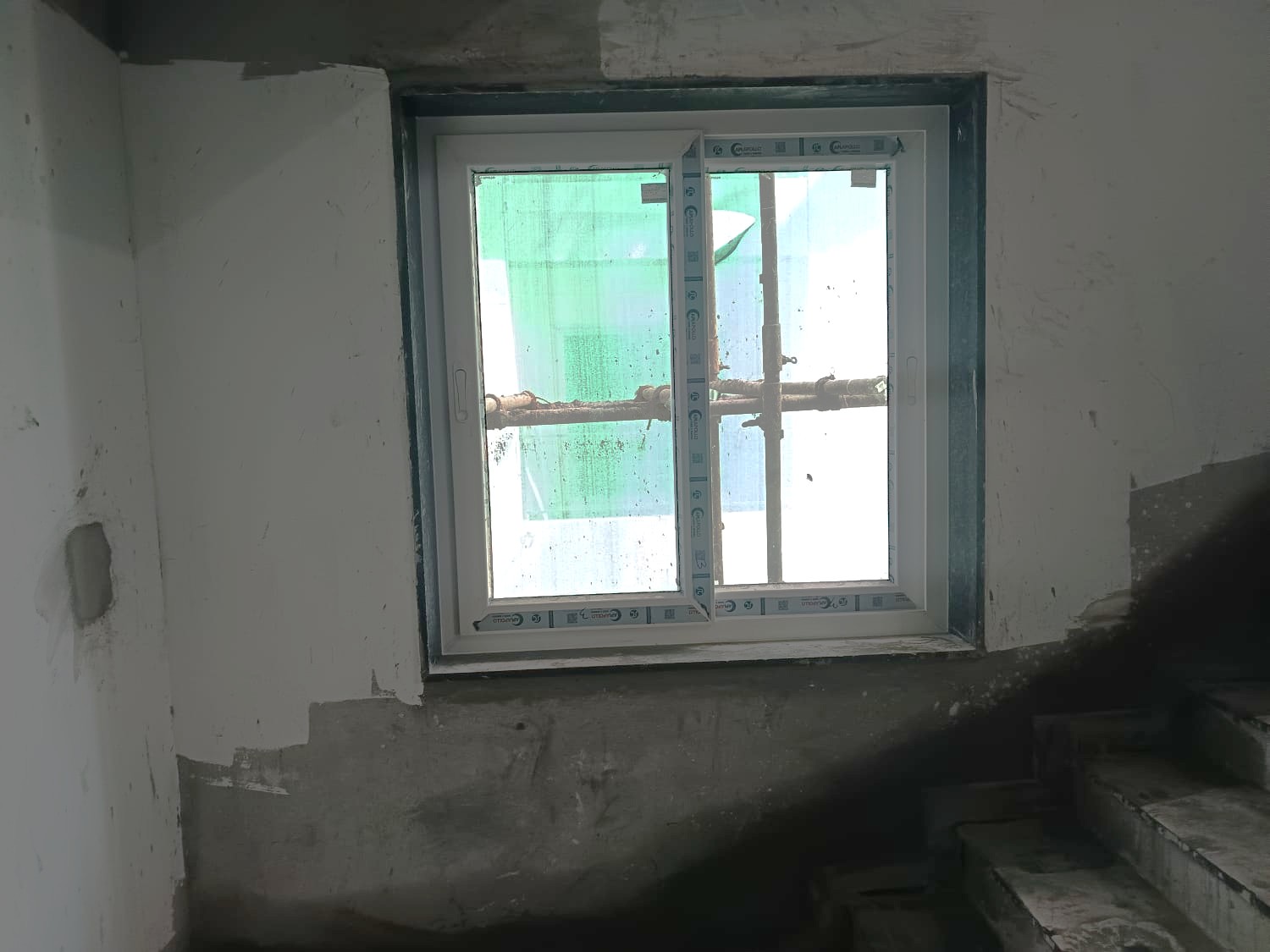

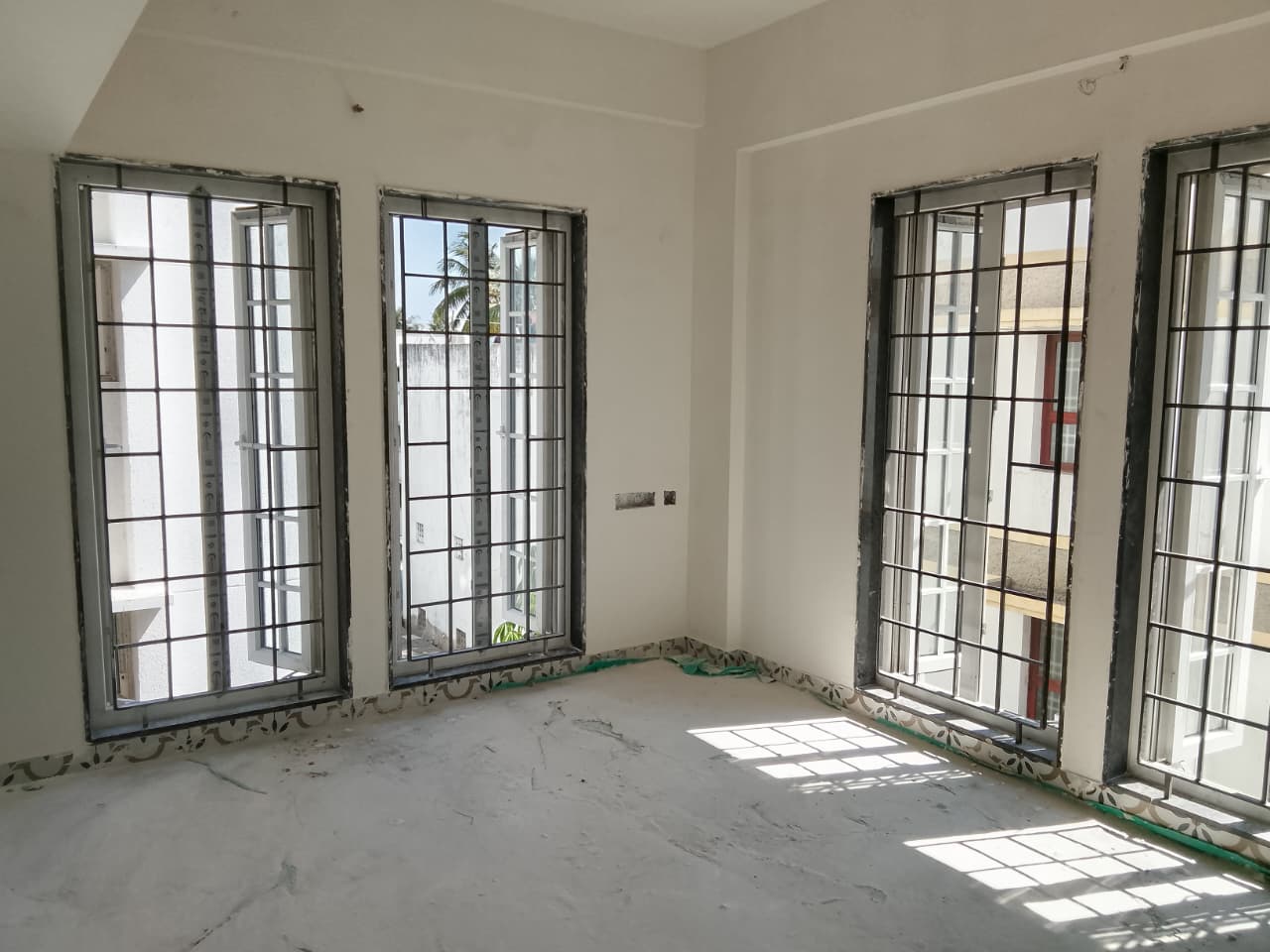

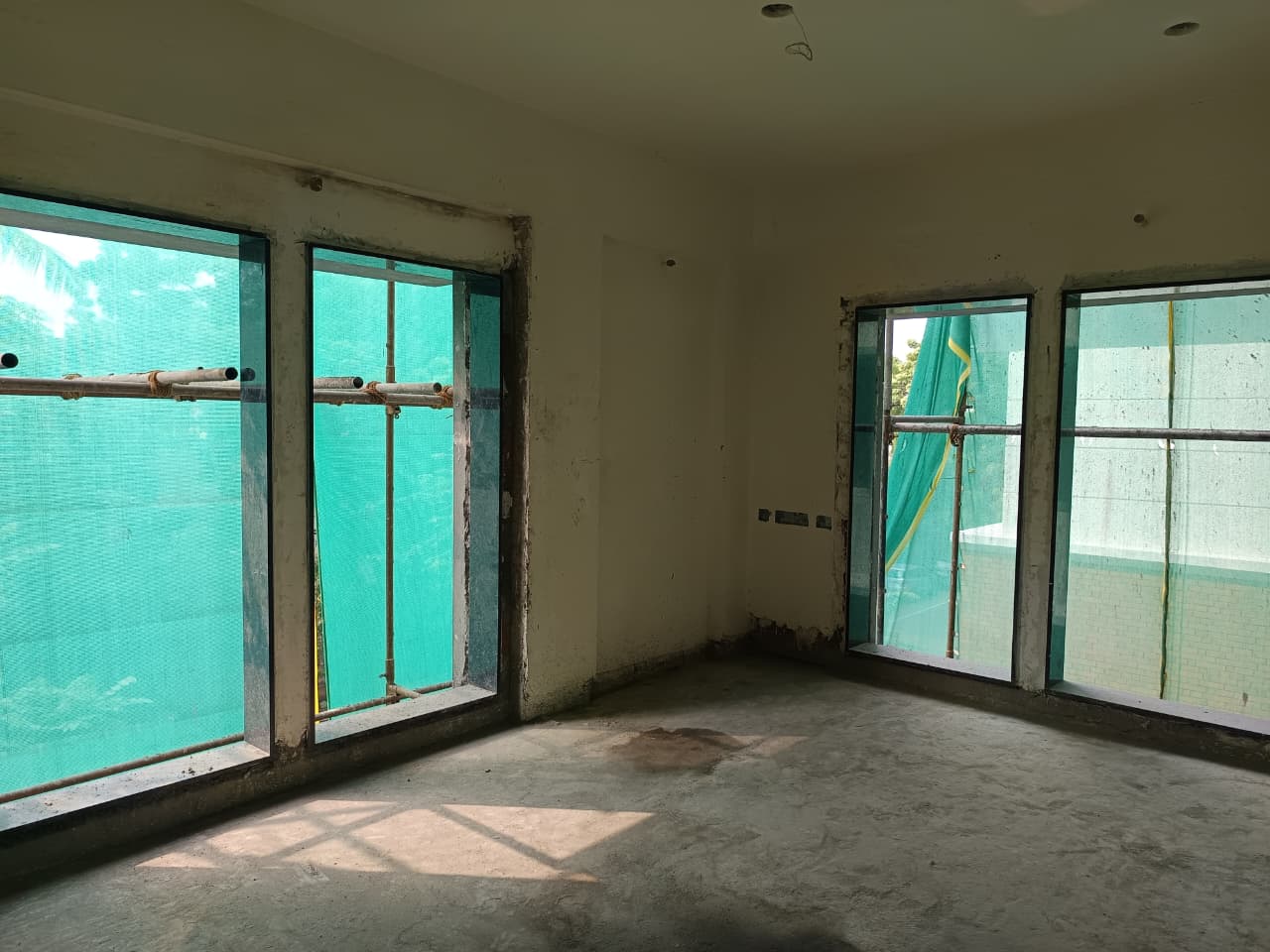

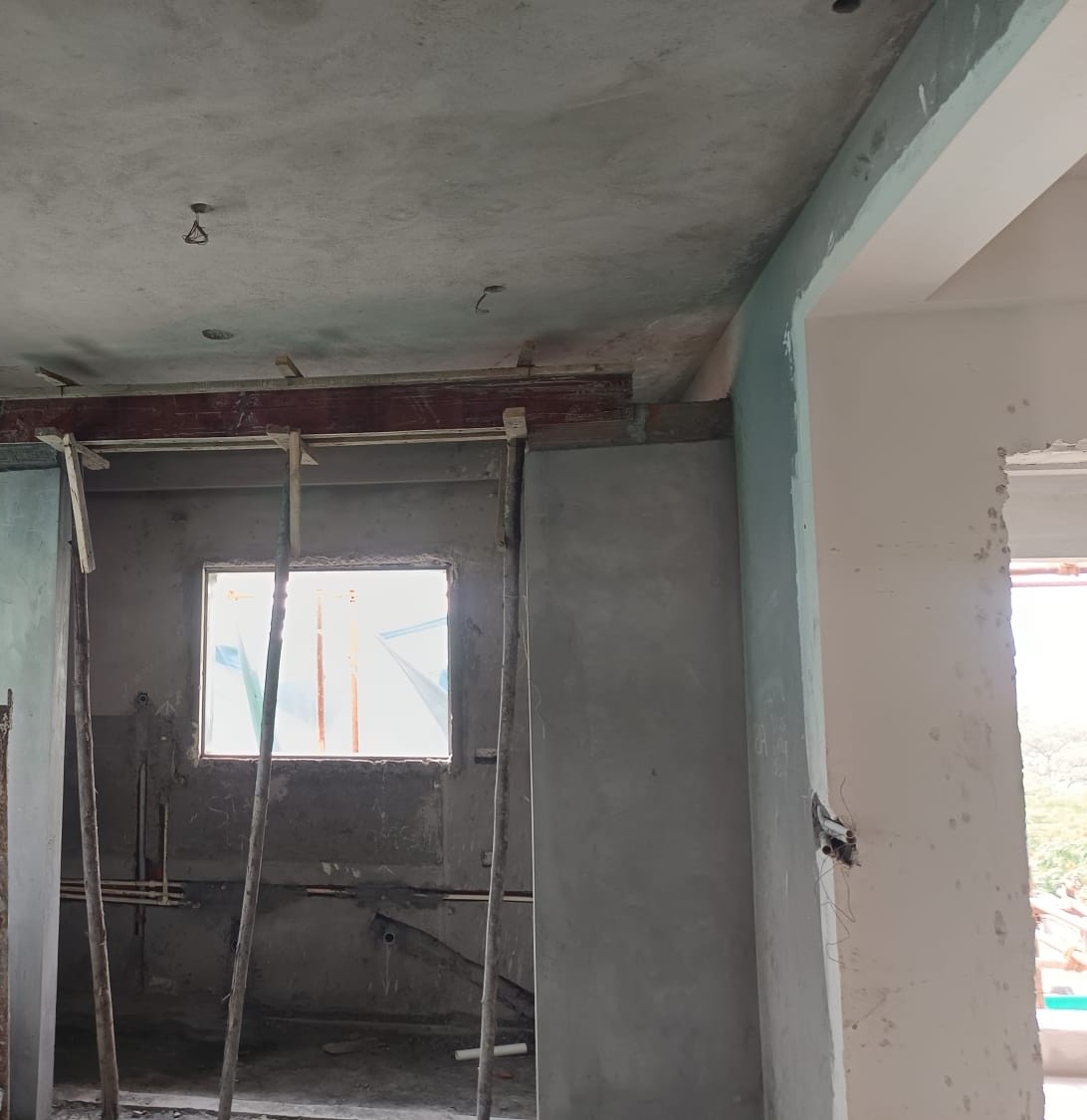

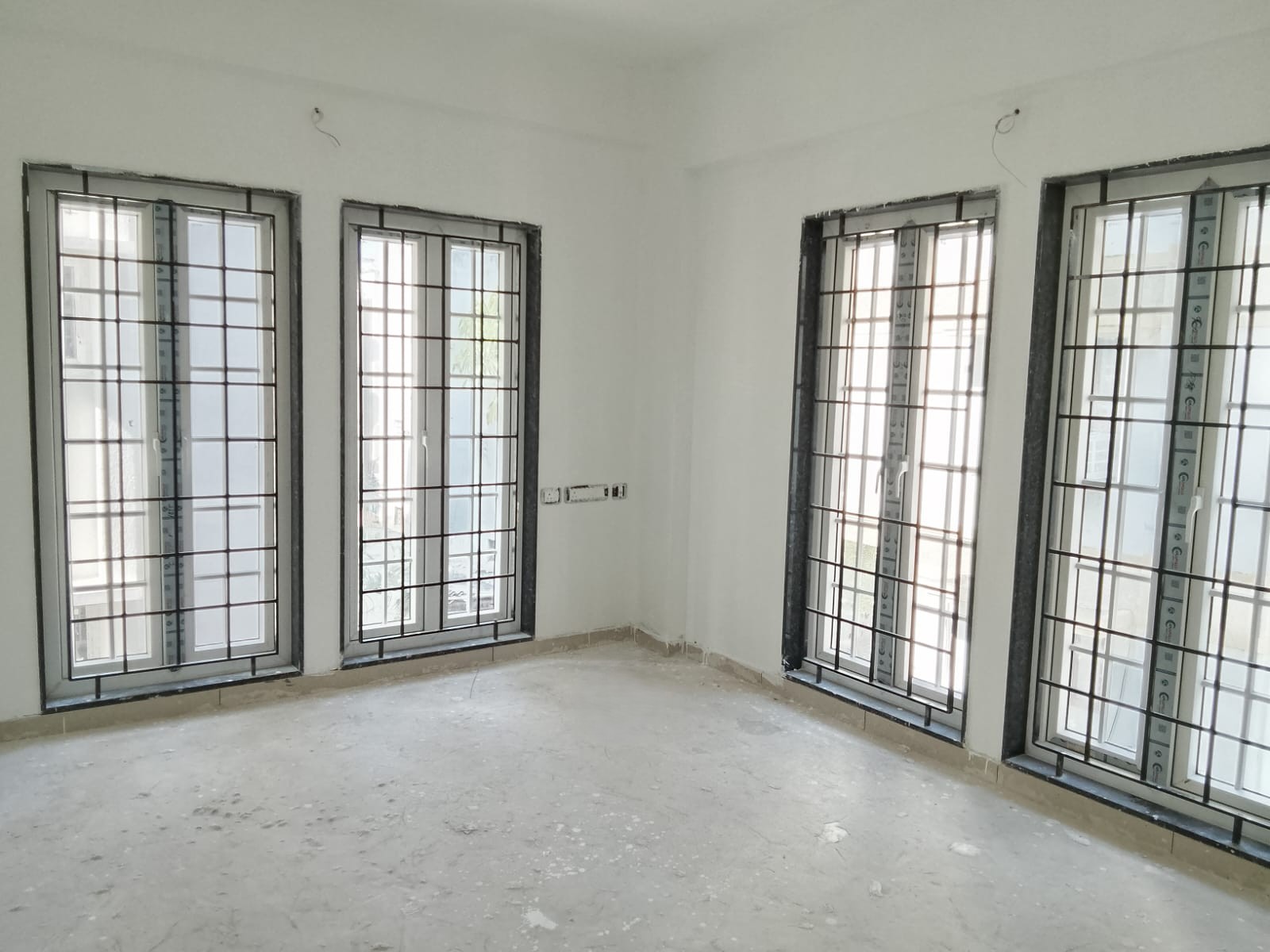

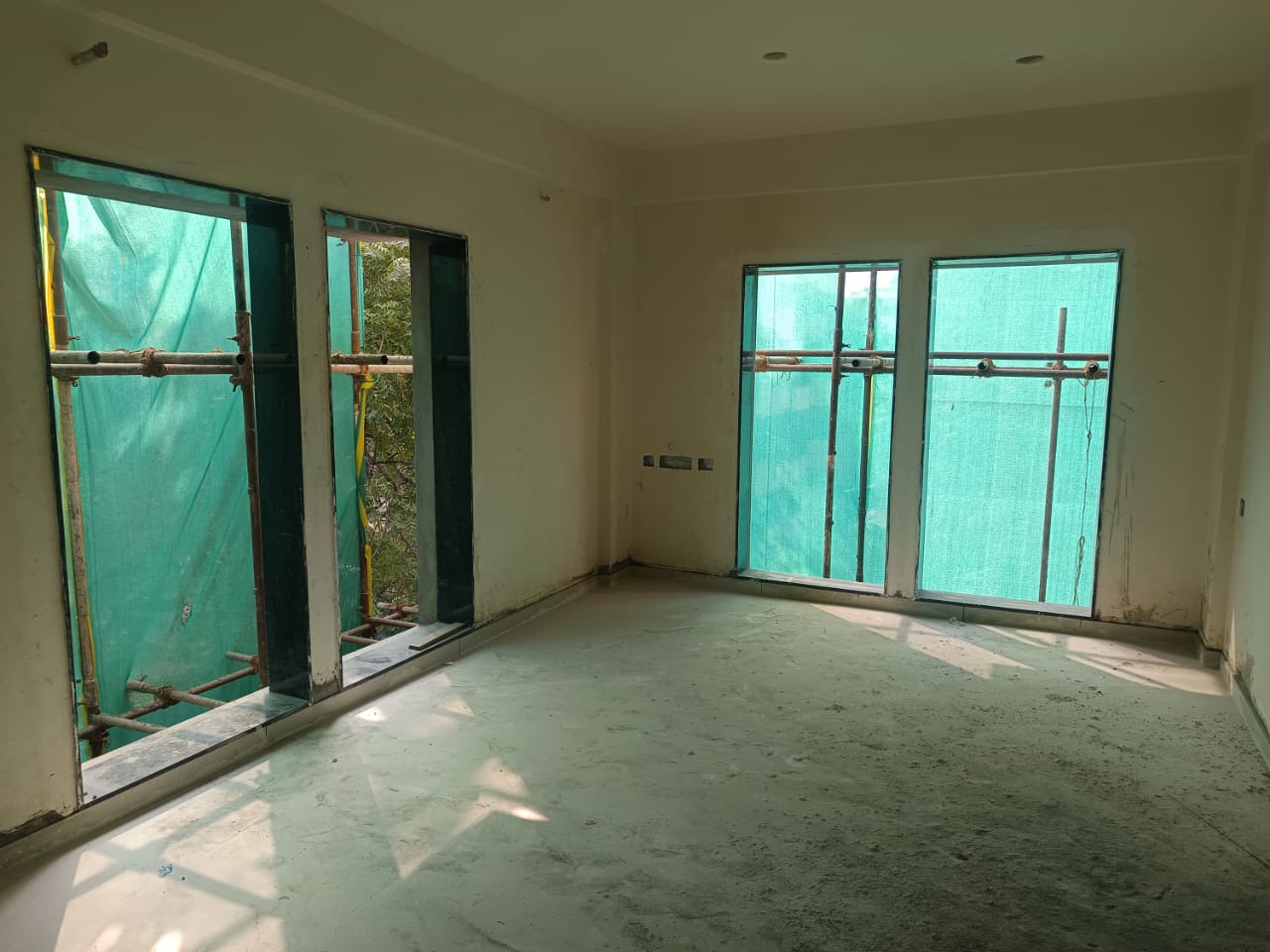

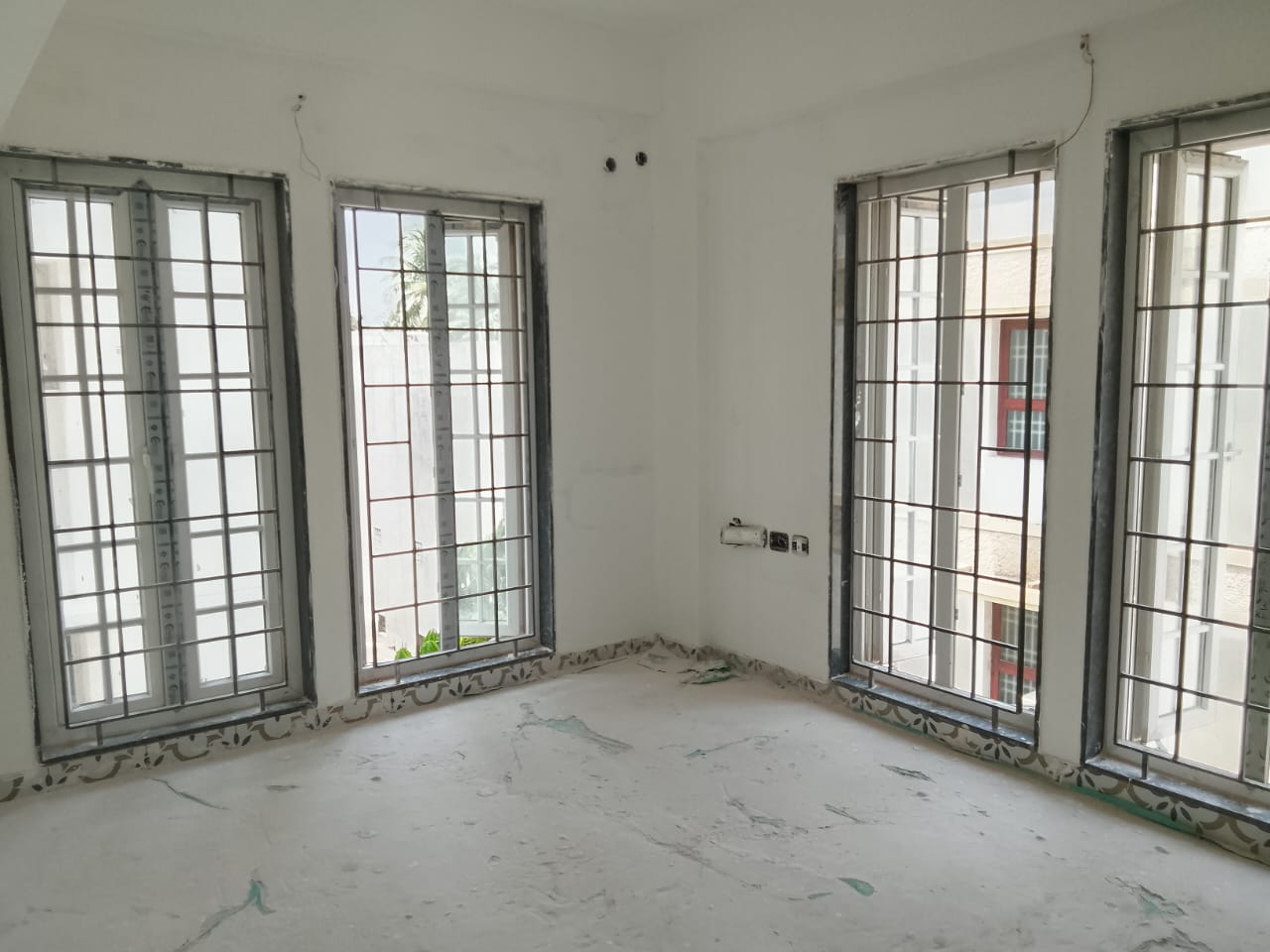

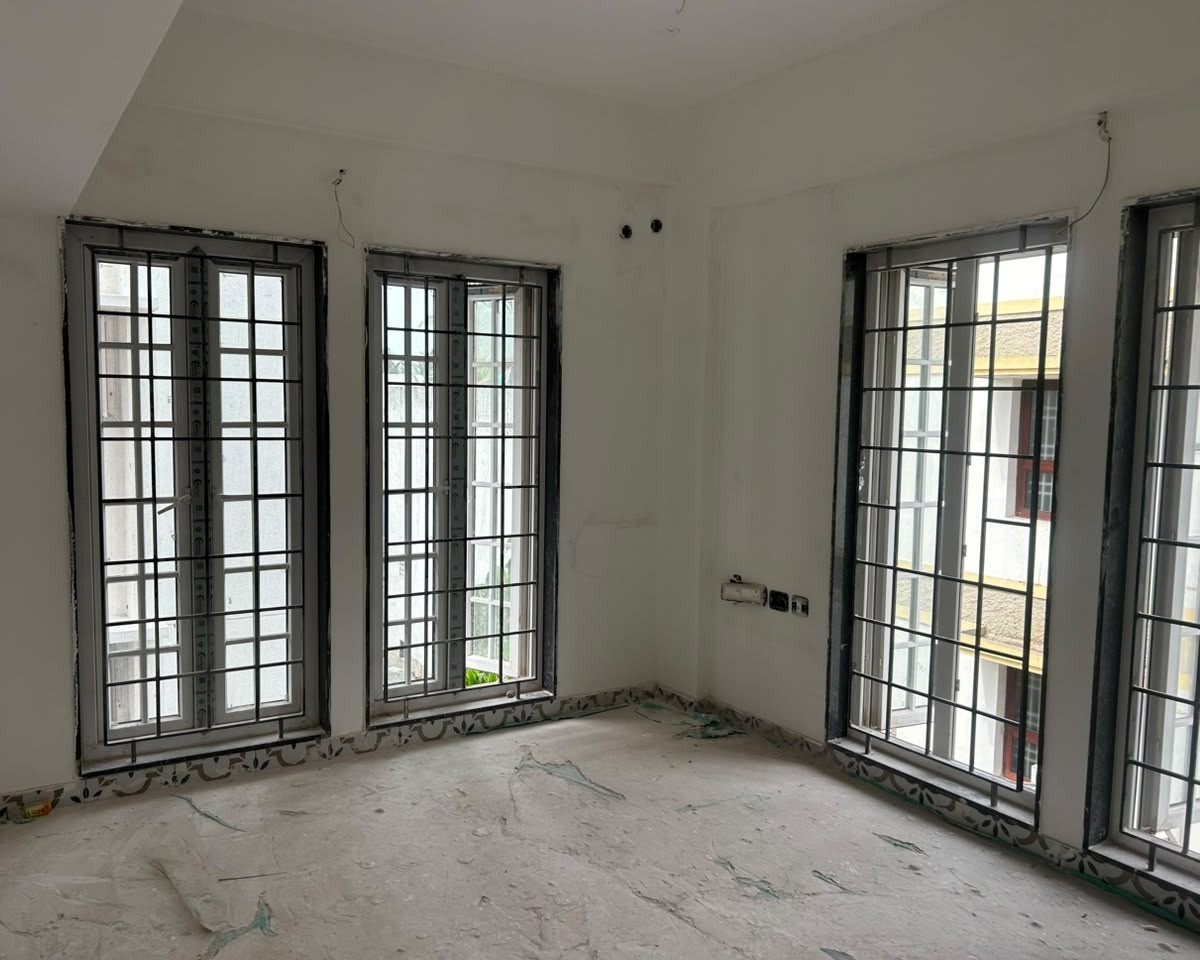

  • All floor windows granite jambs work is completed.

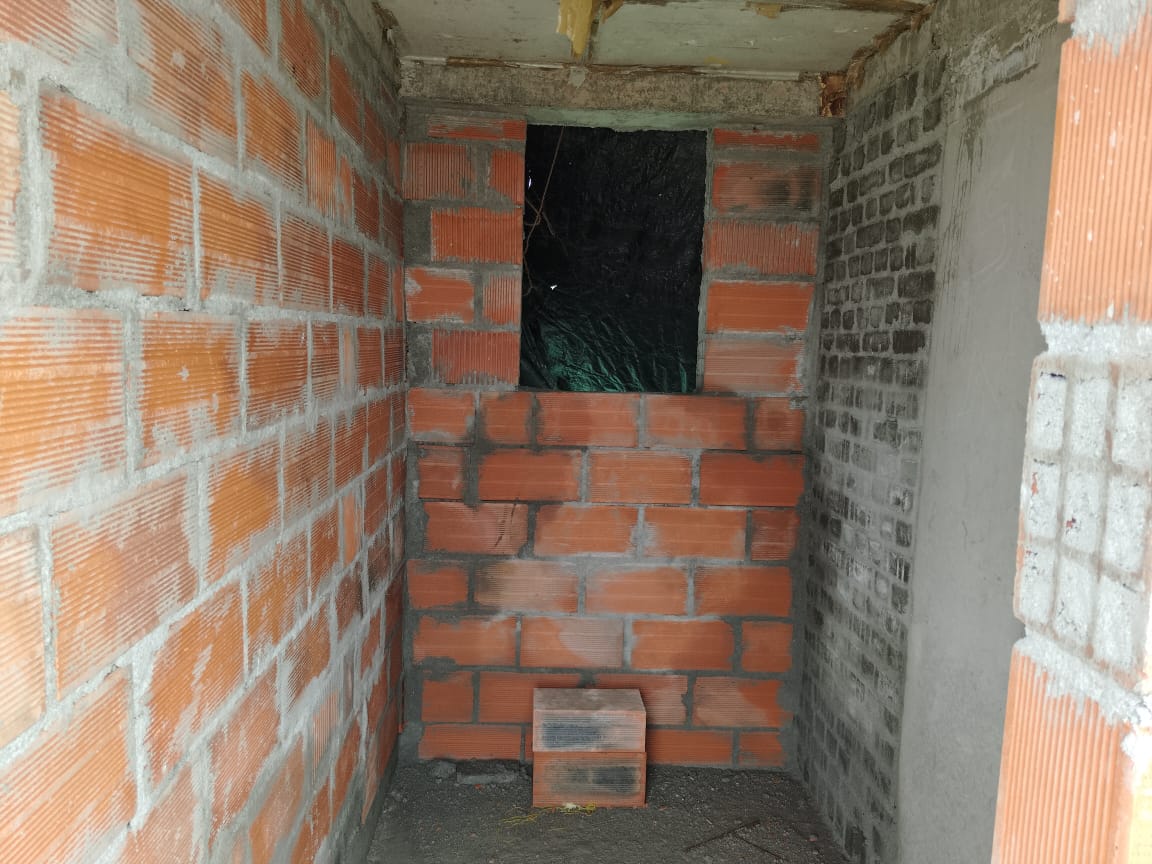

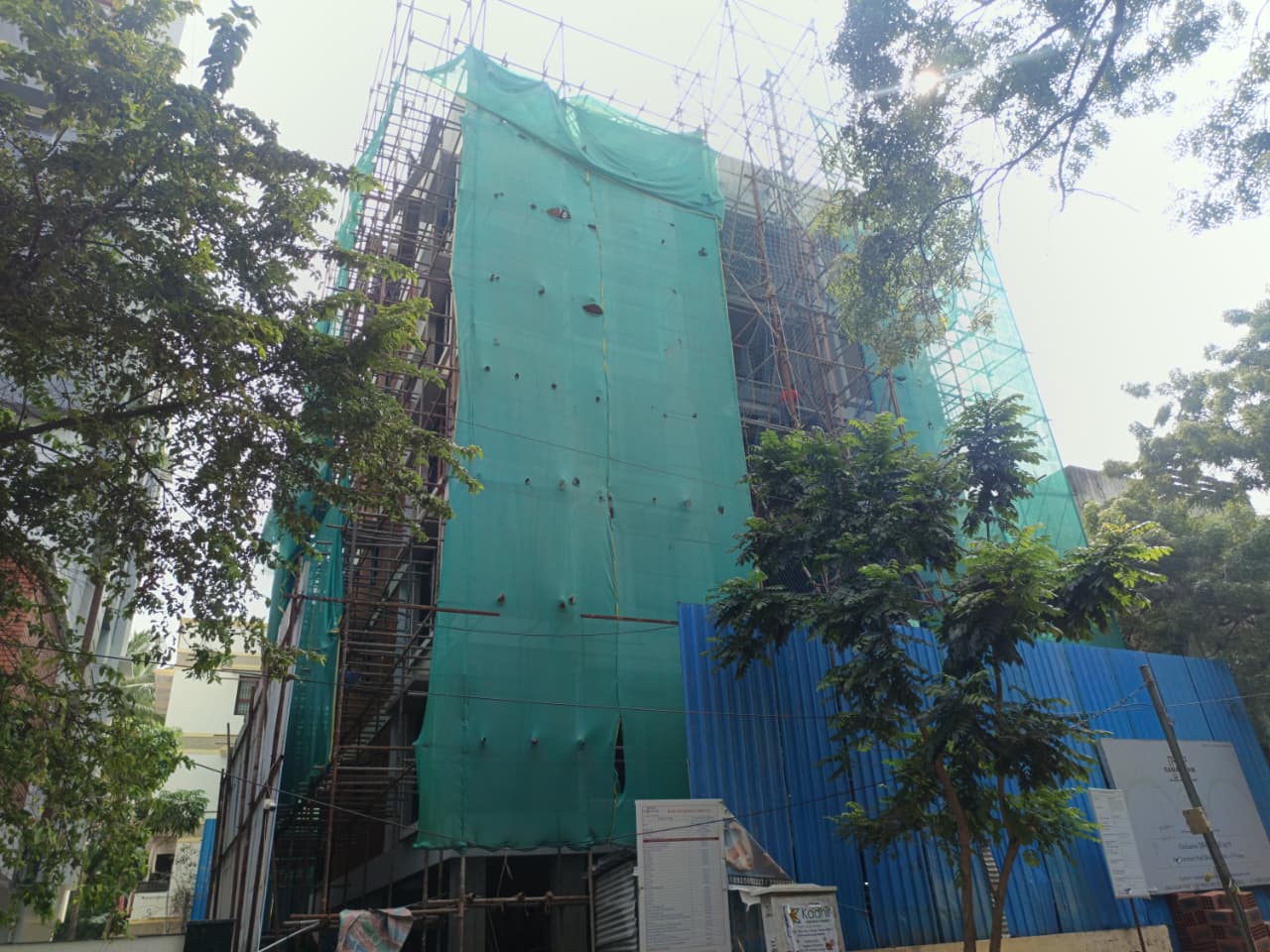

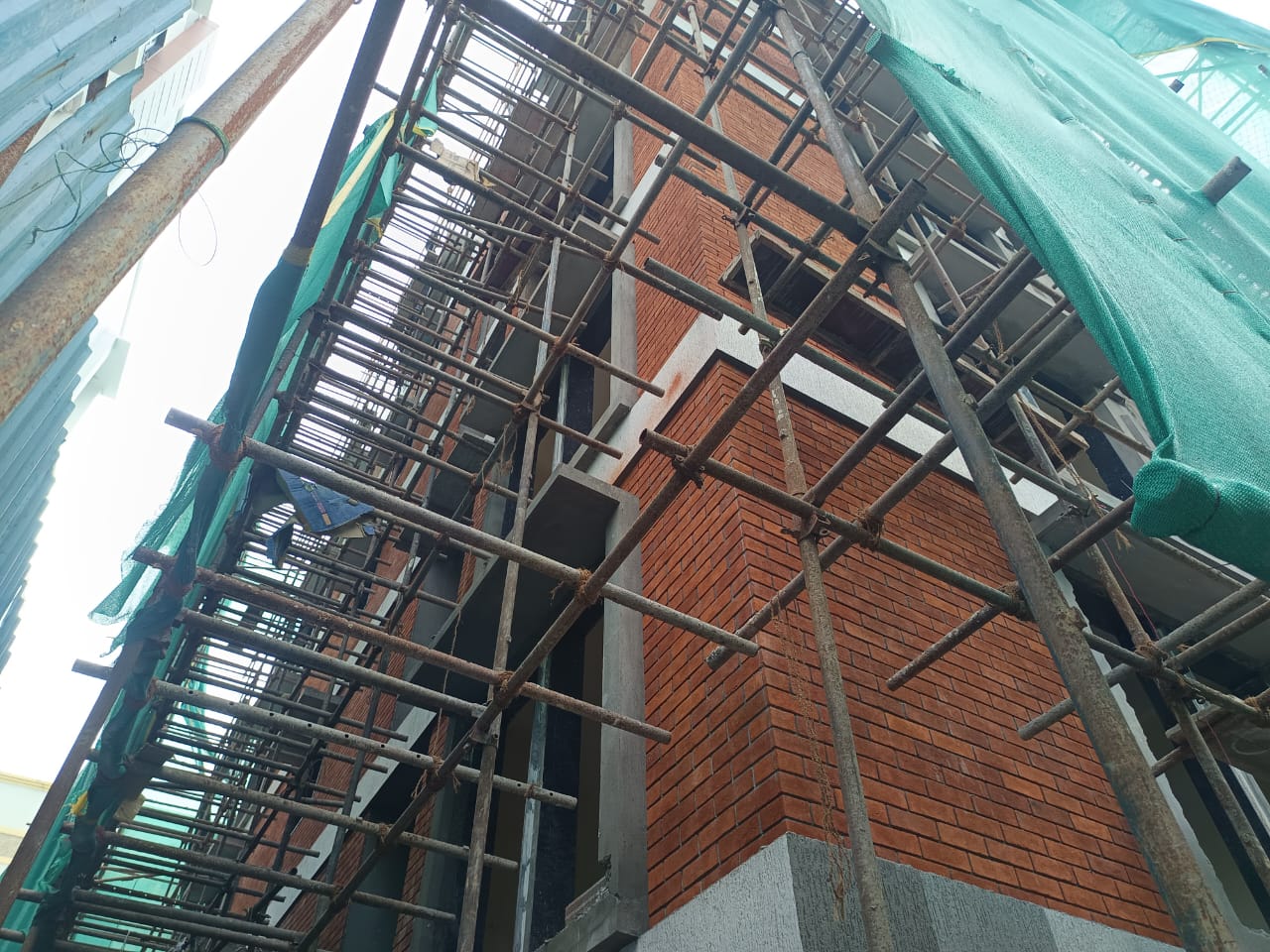

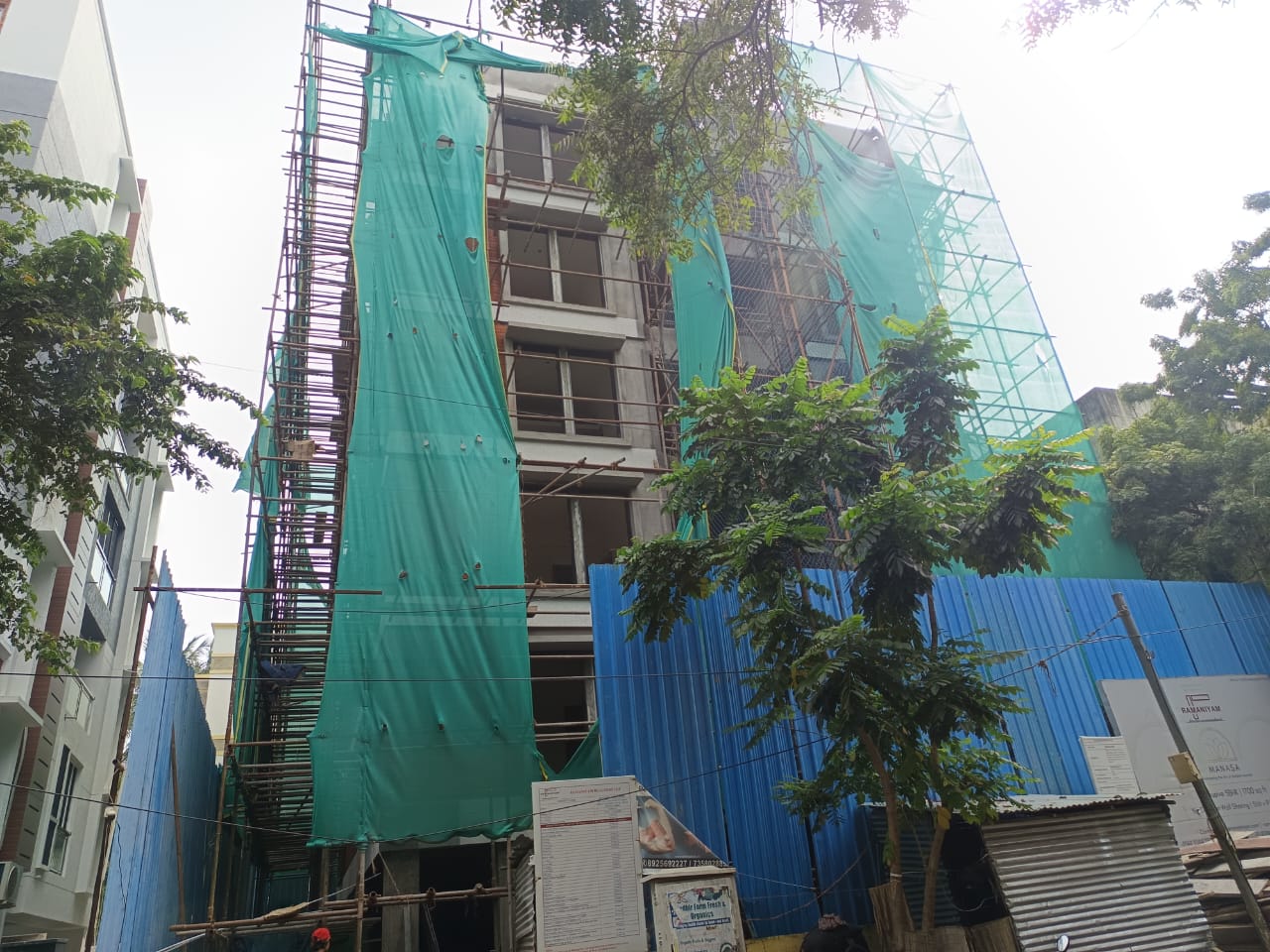

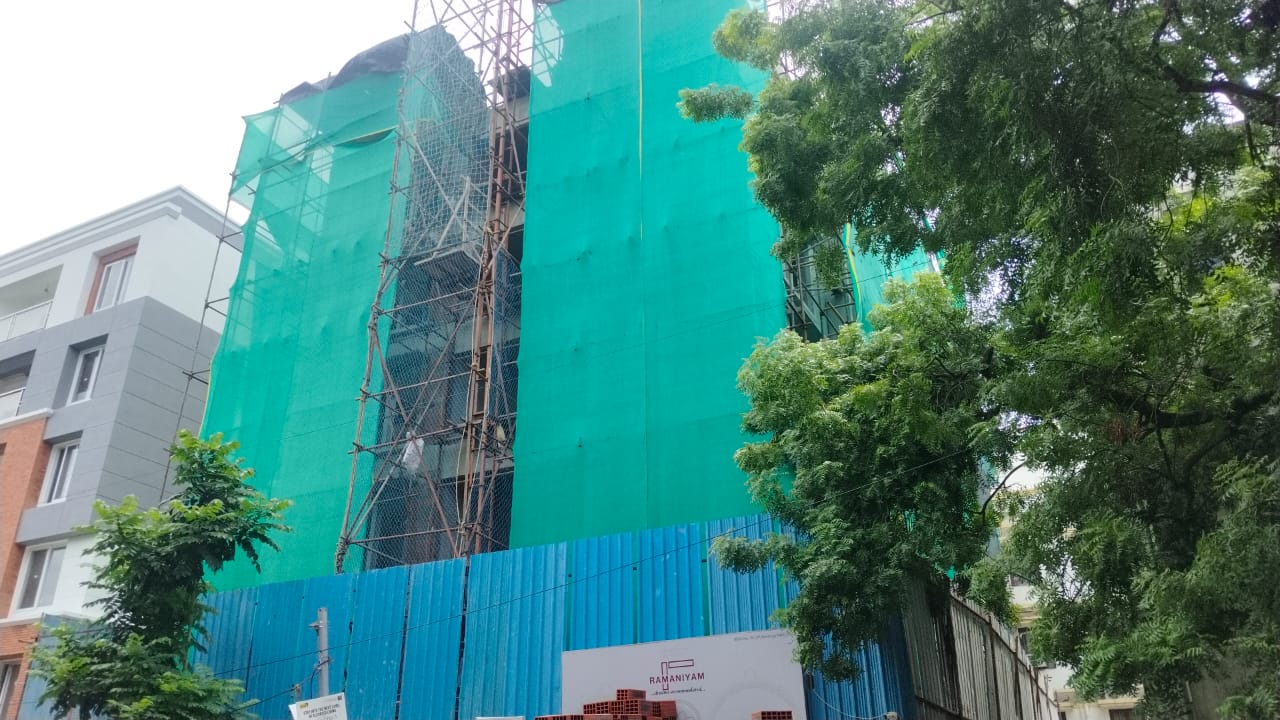

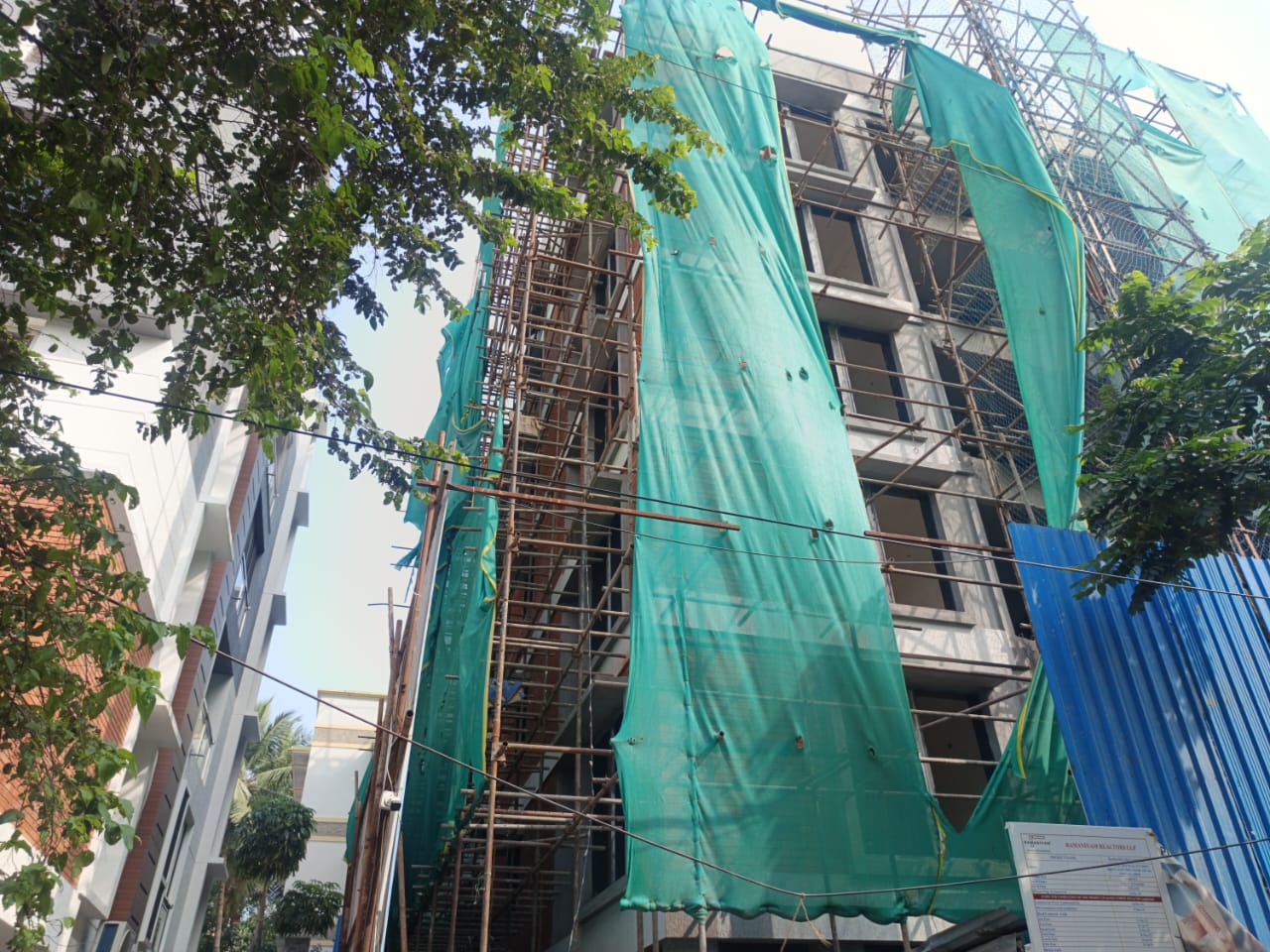

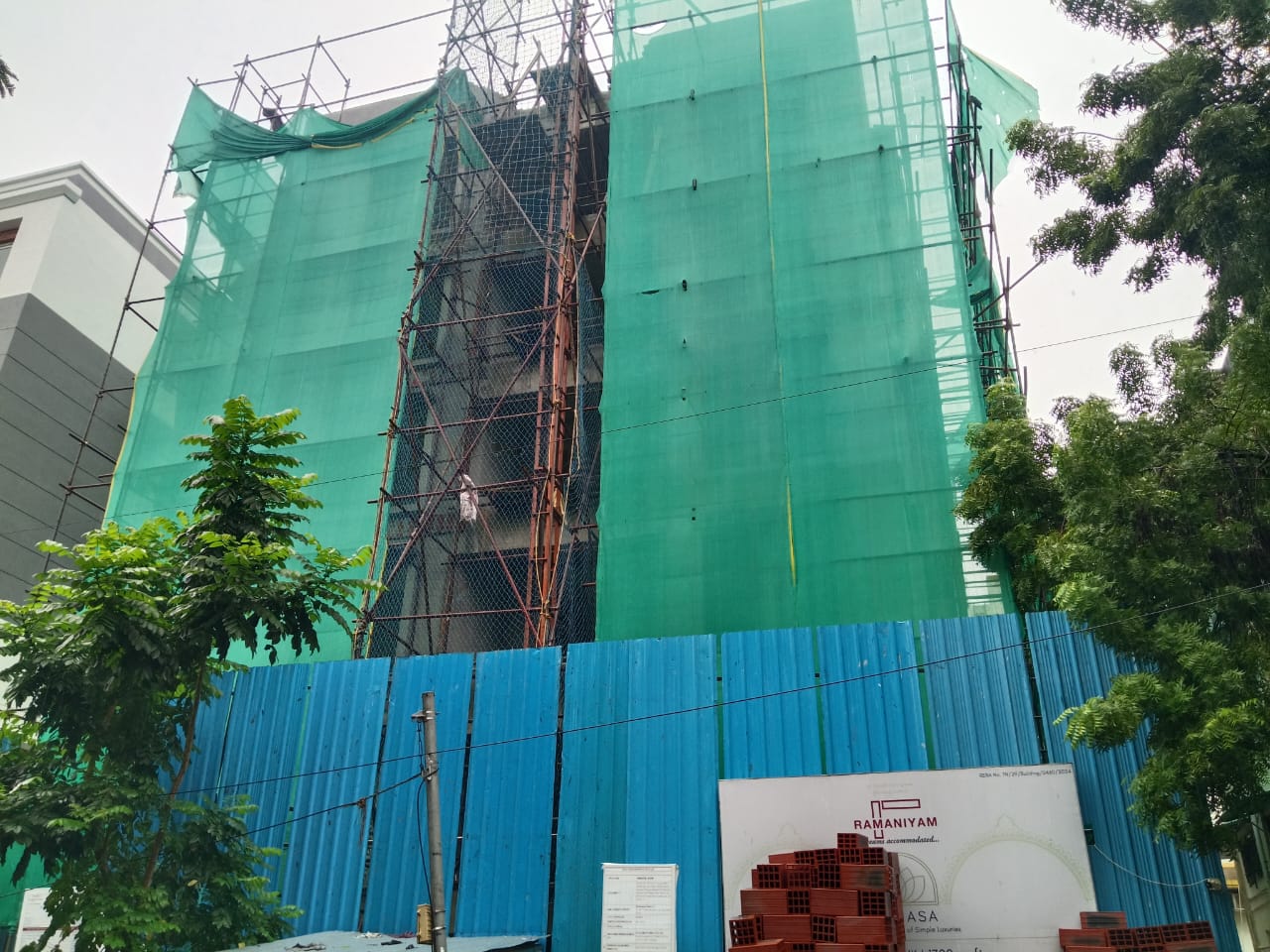

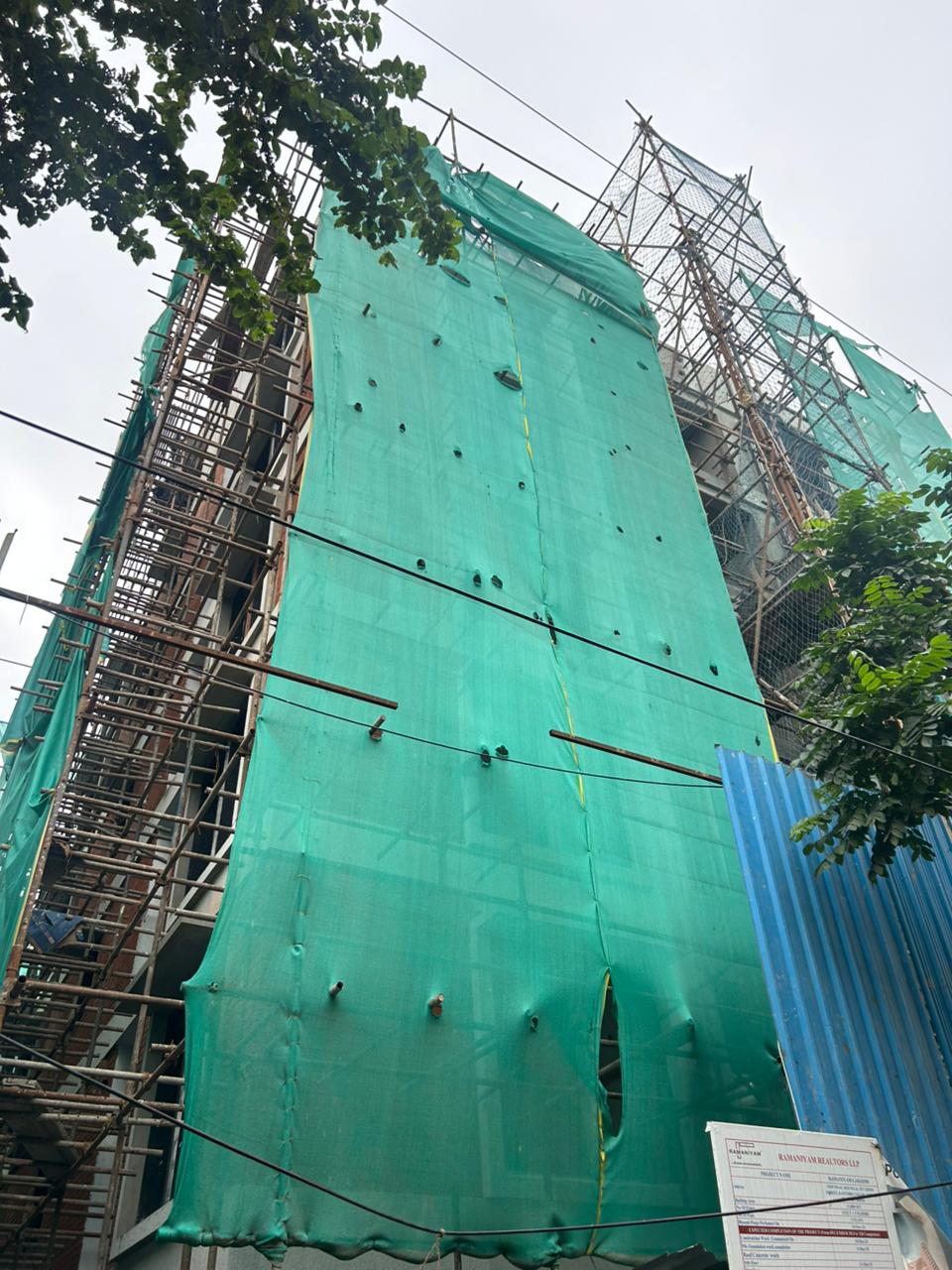

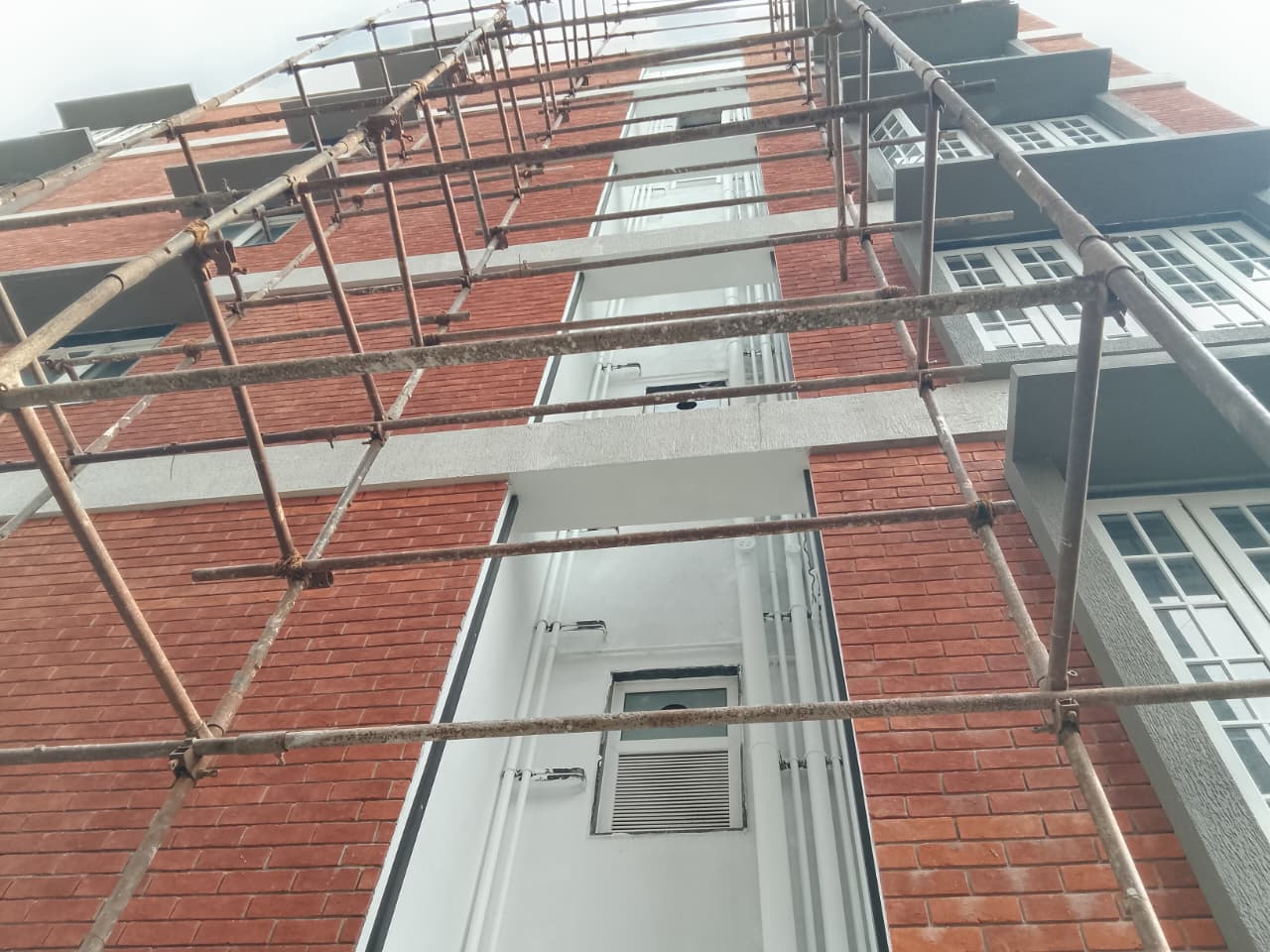

  • Elevation wall cladding tiles work is in progress.(70% completed)

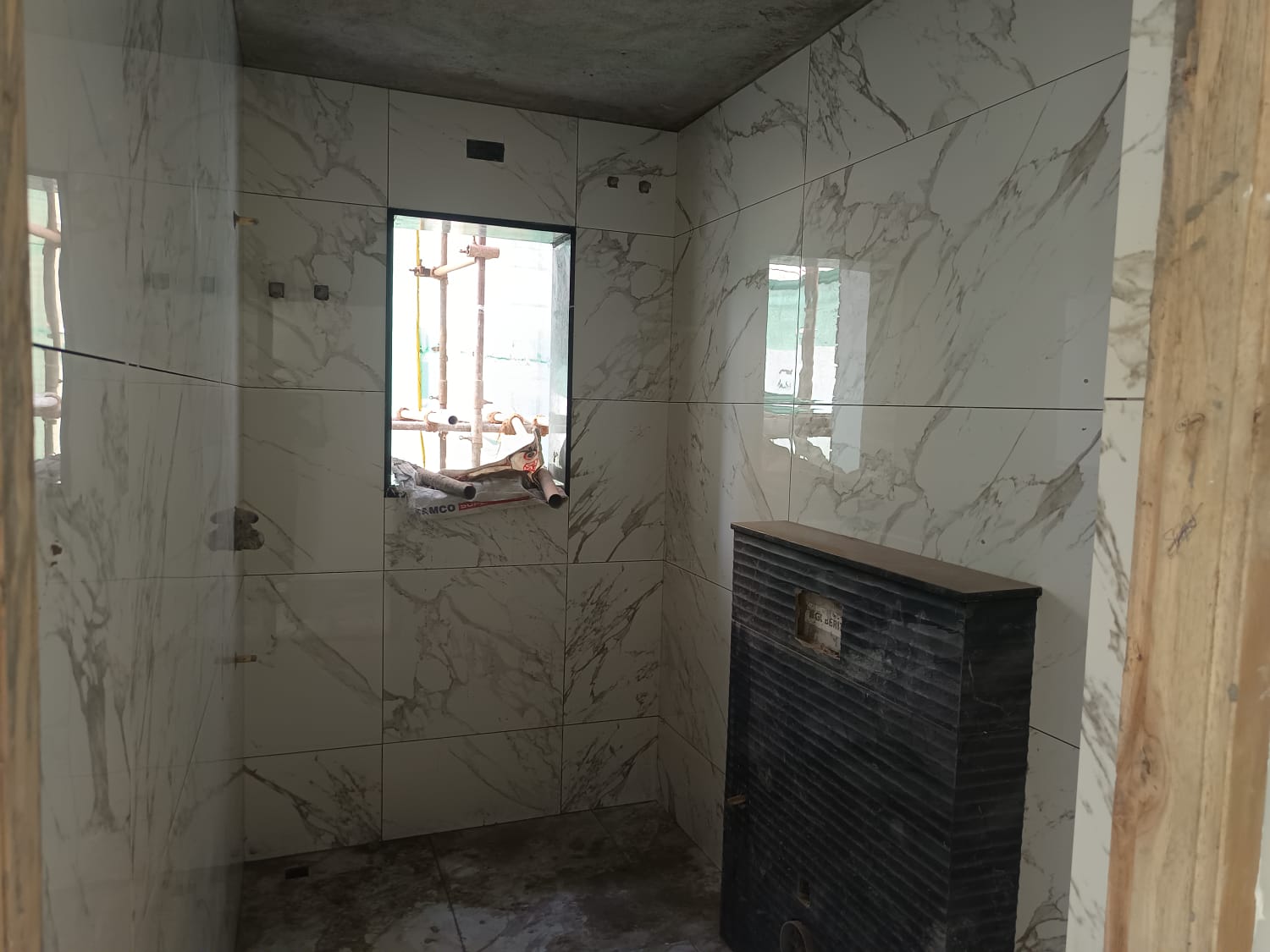

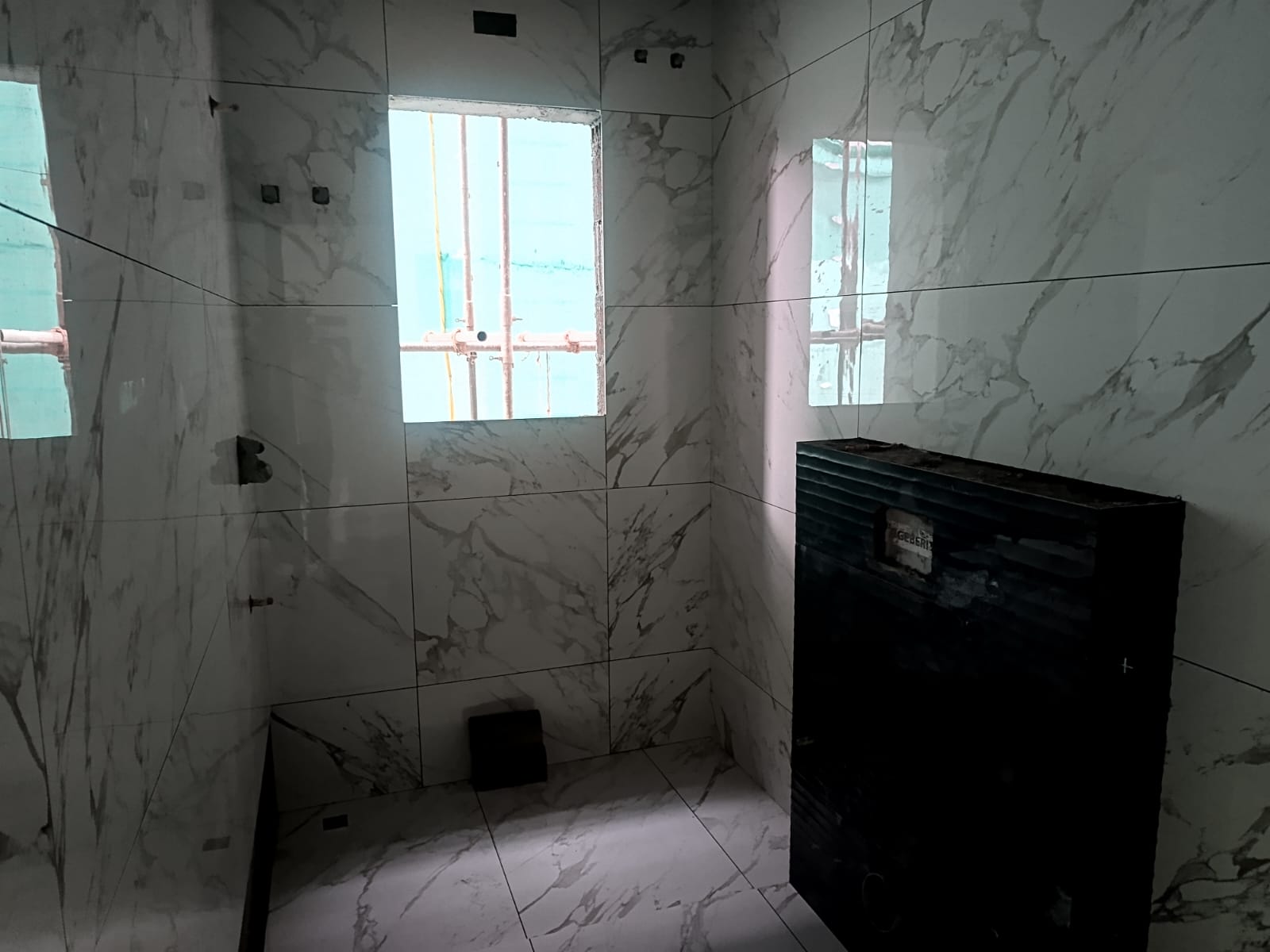

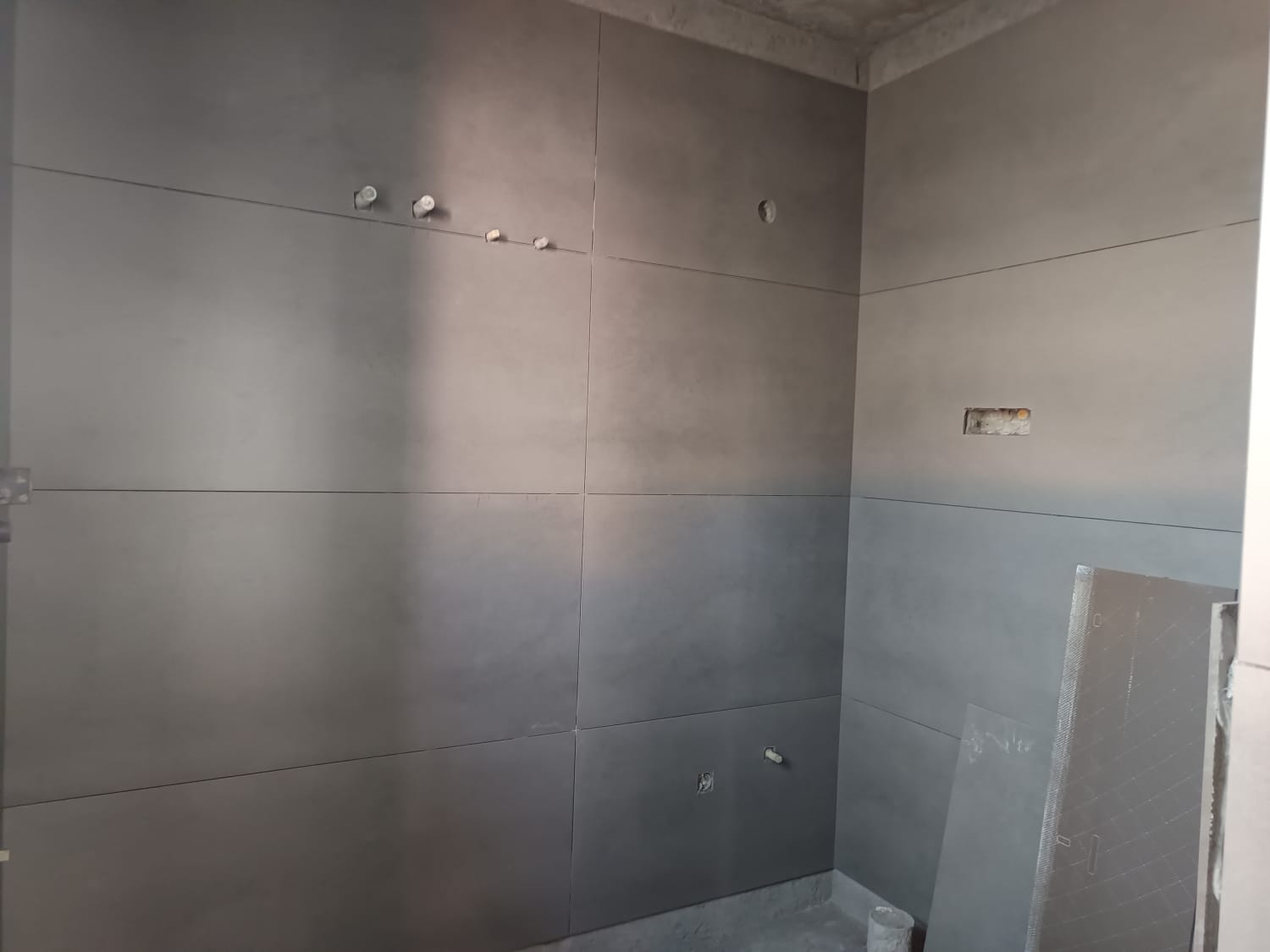

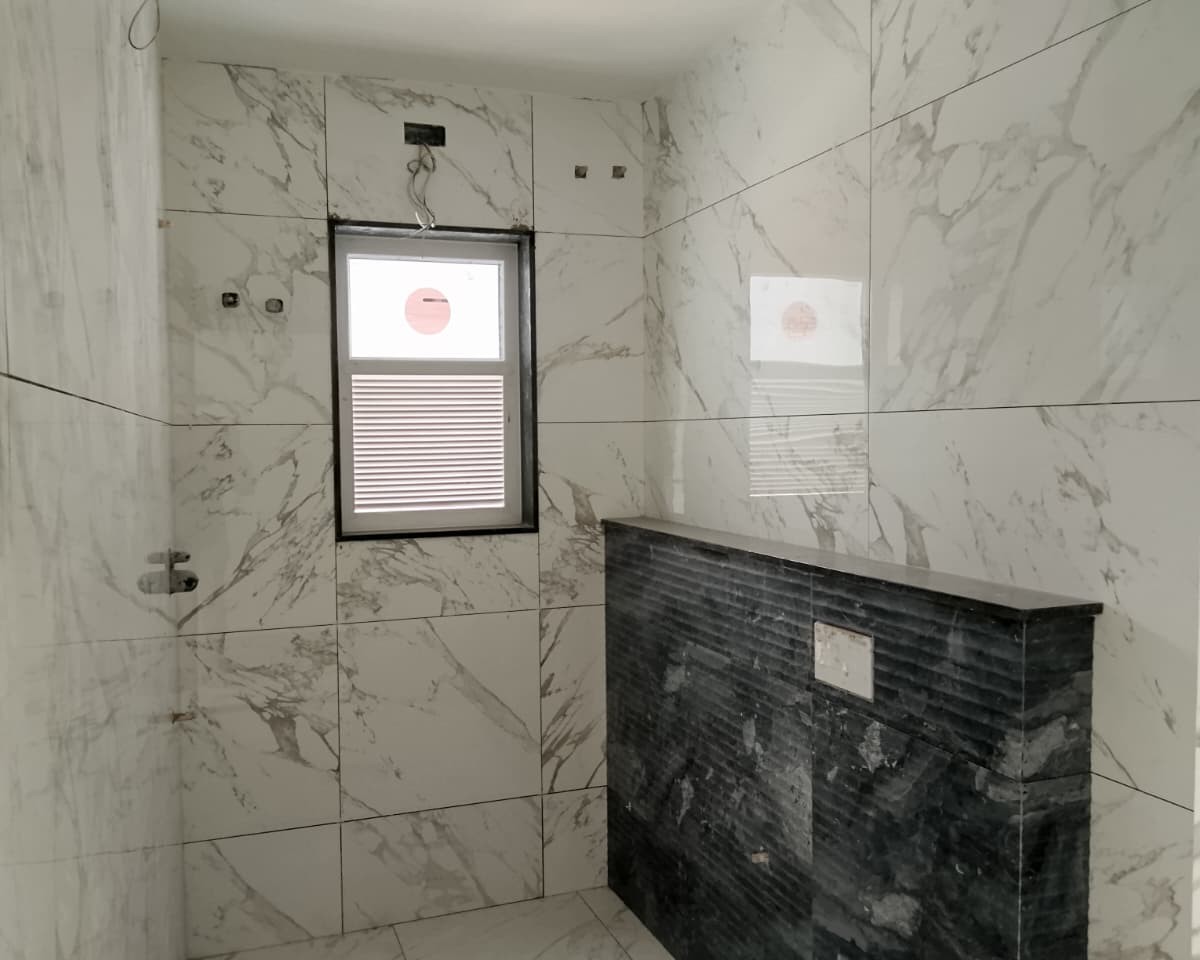

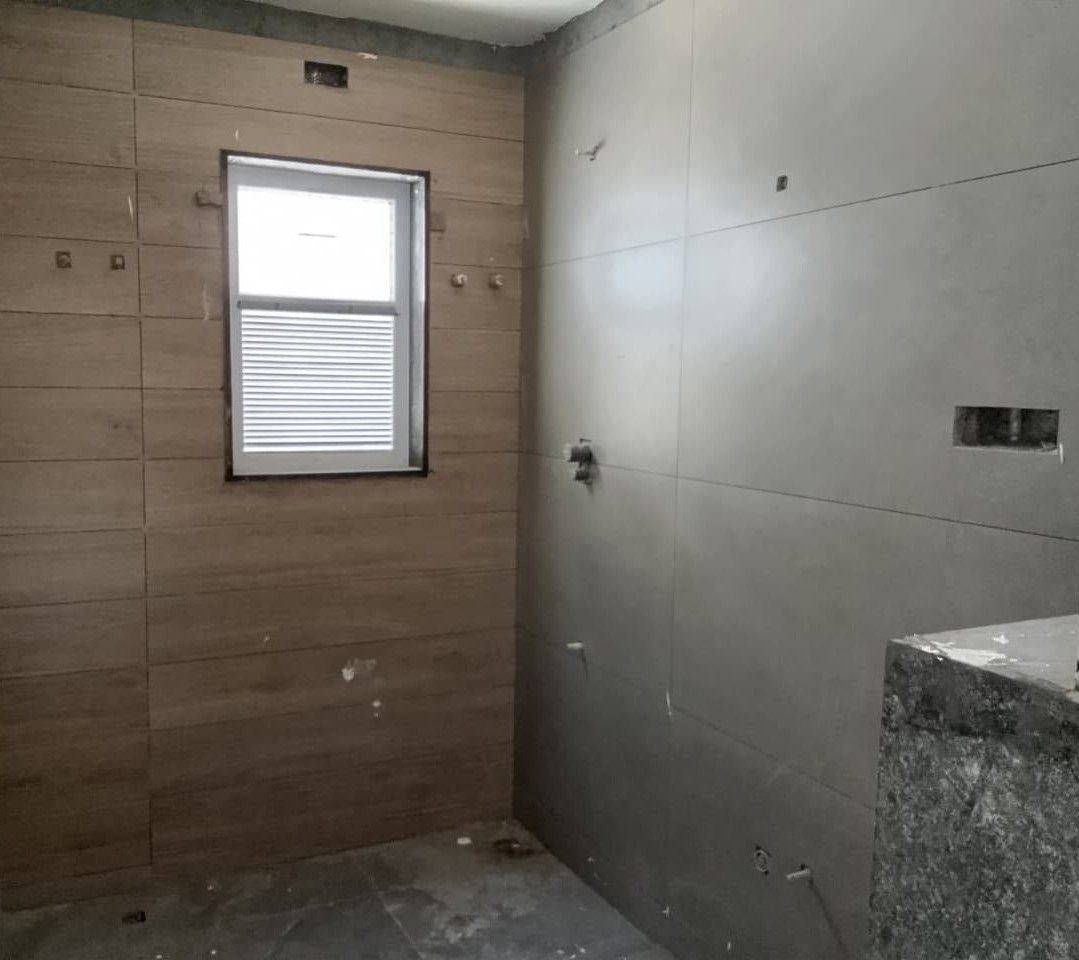

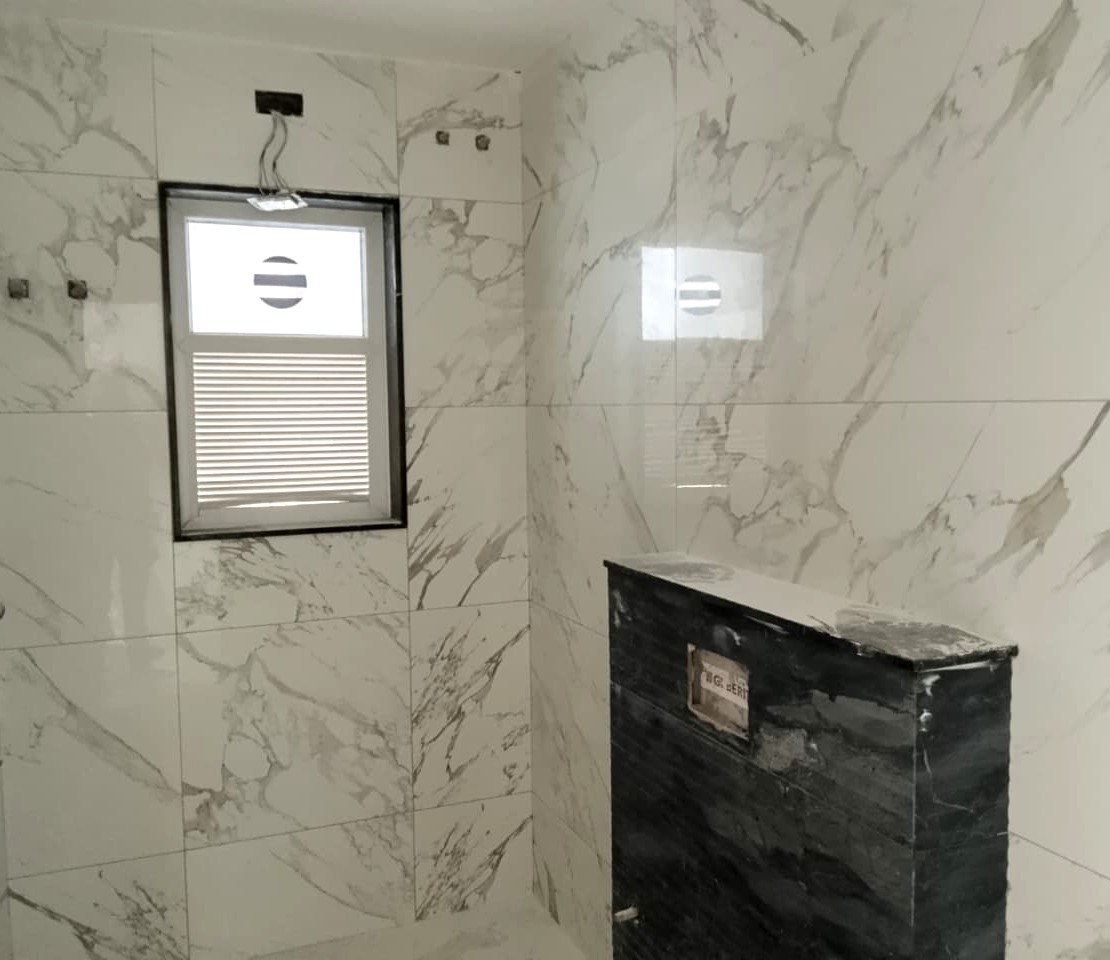

  • Toilet wall tiles work is in progress.(1stand 2nd floor completed)

  • Texture painting work is in progress.(90% completed)

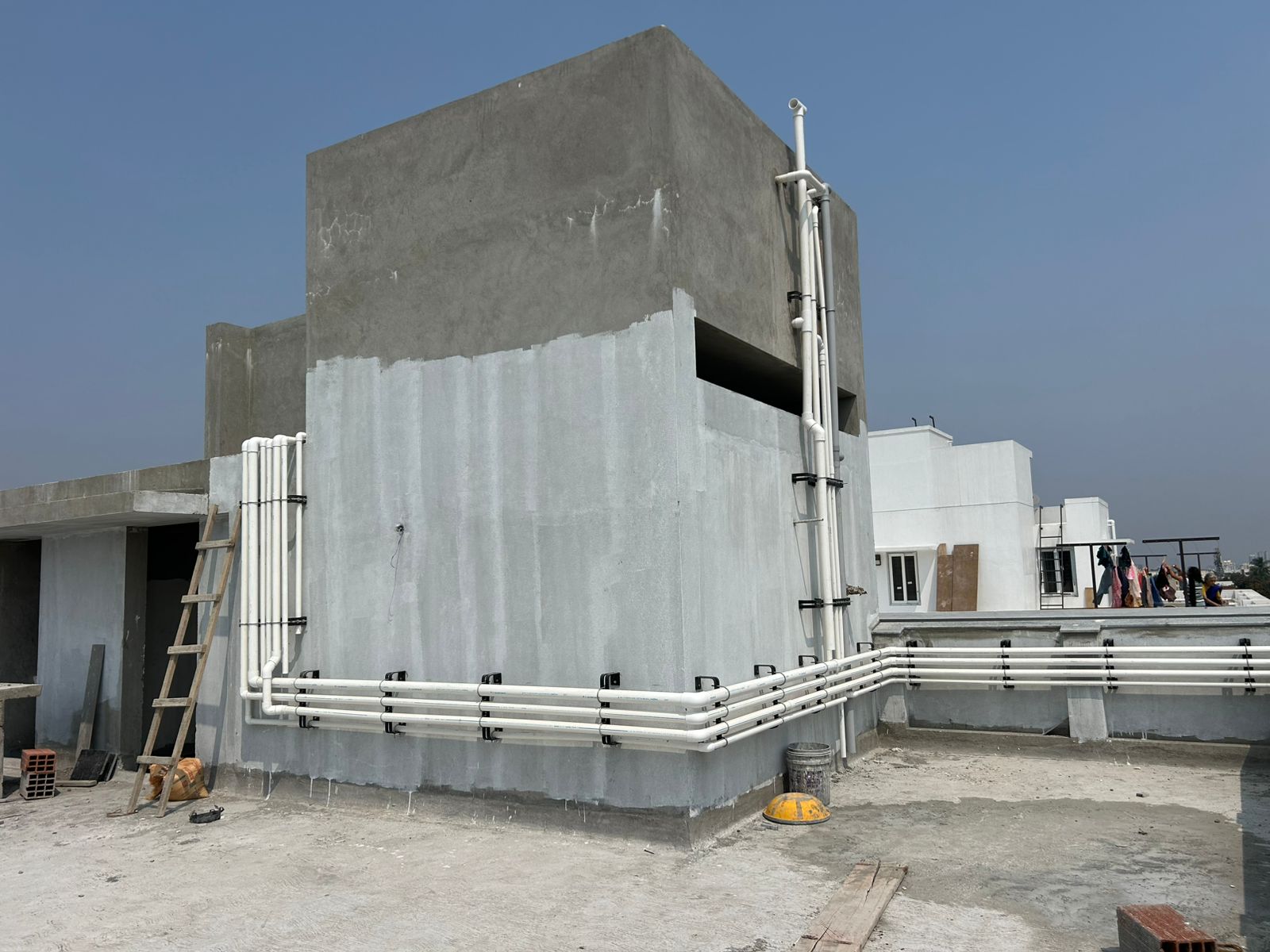

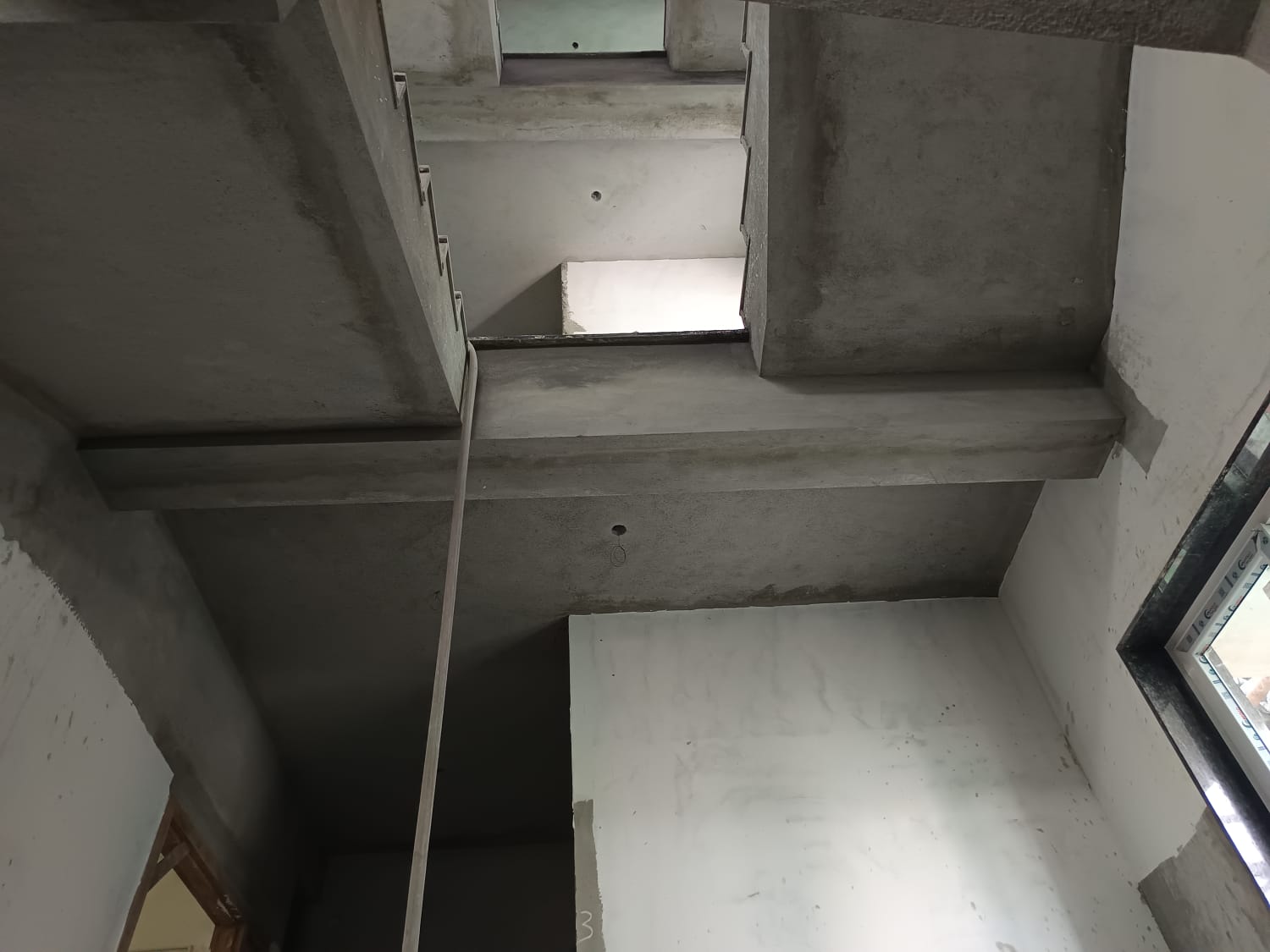

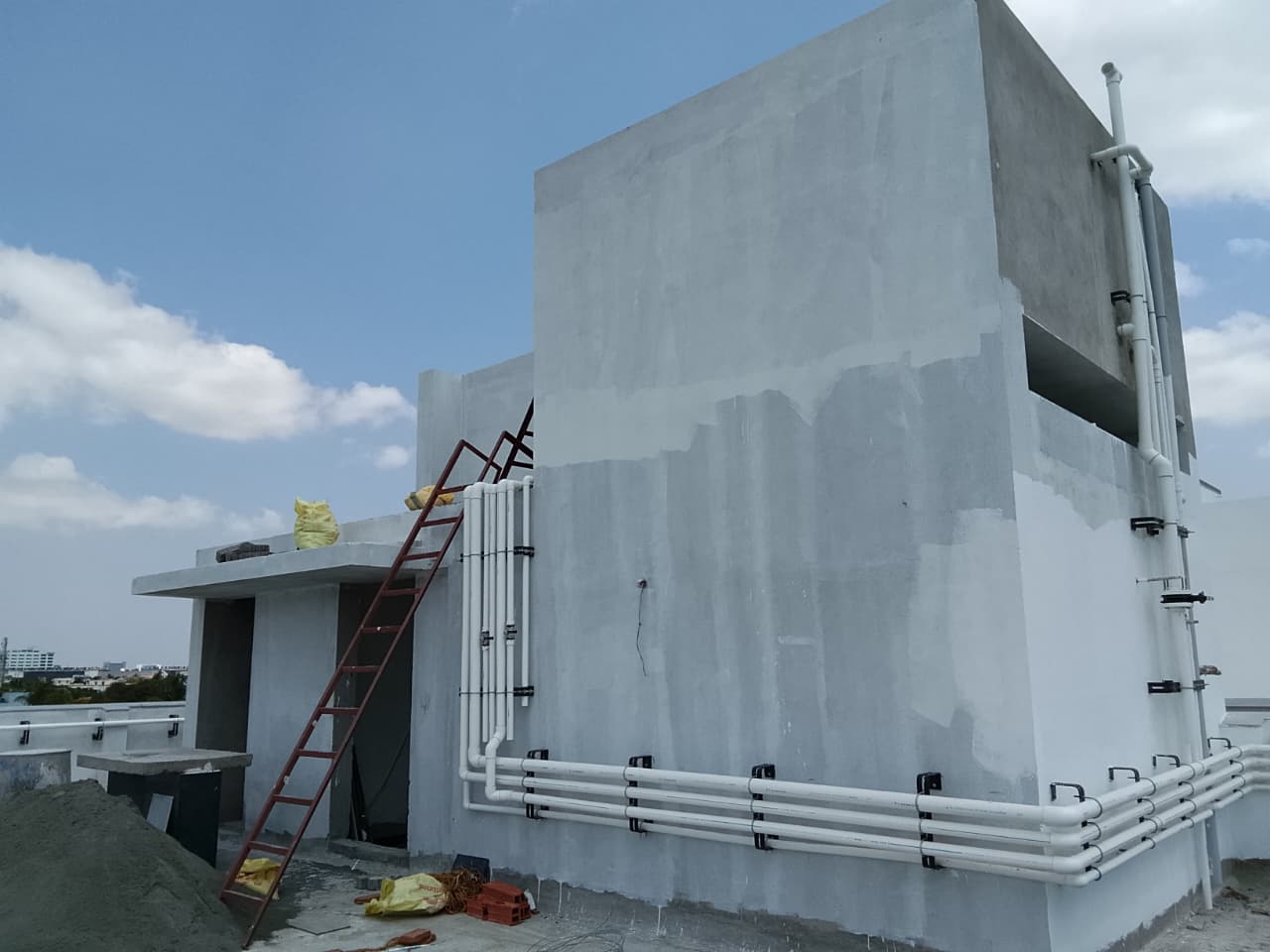

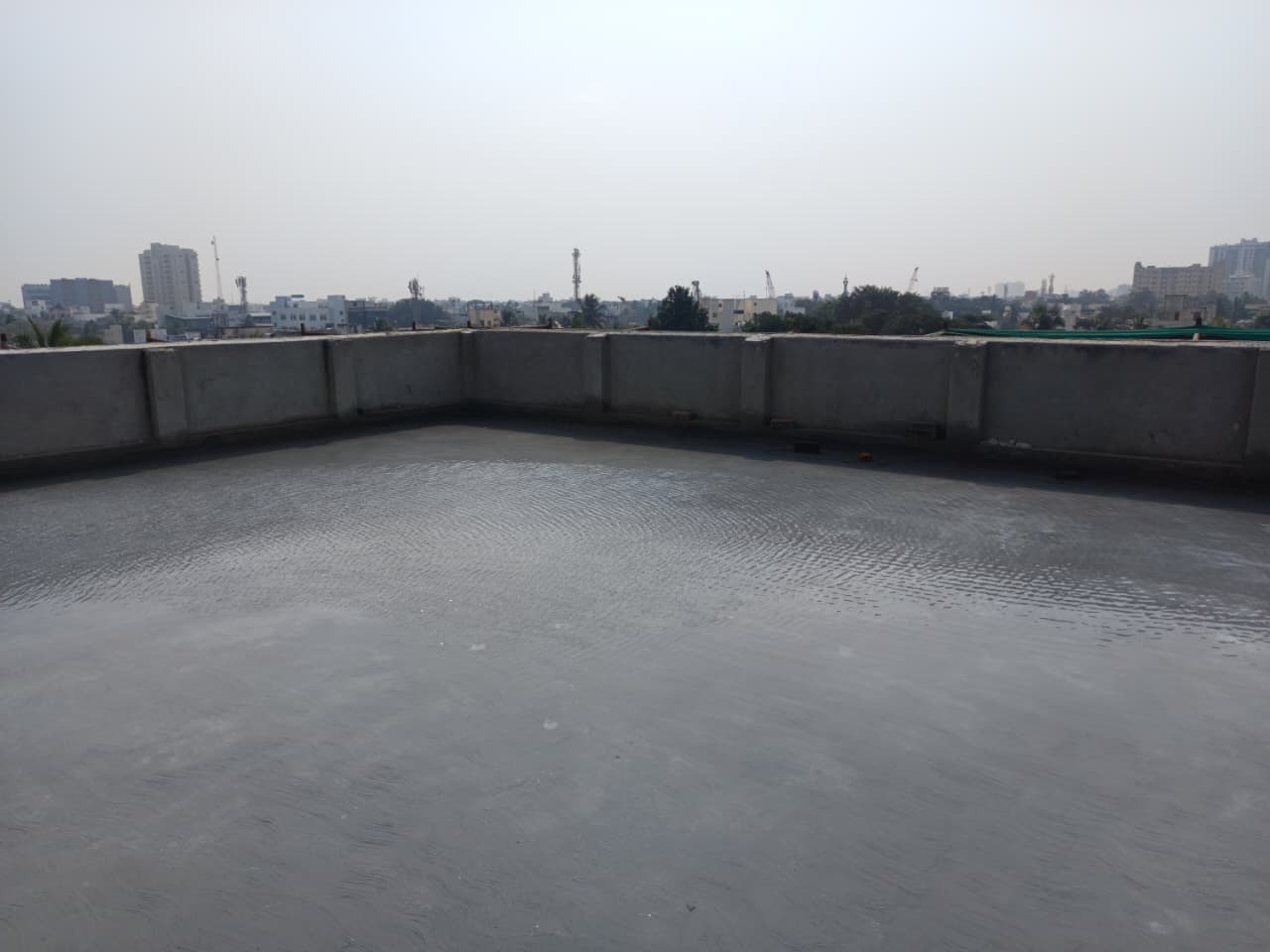

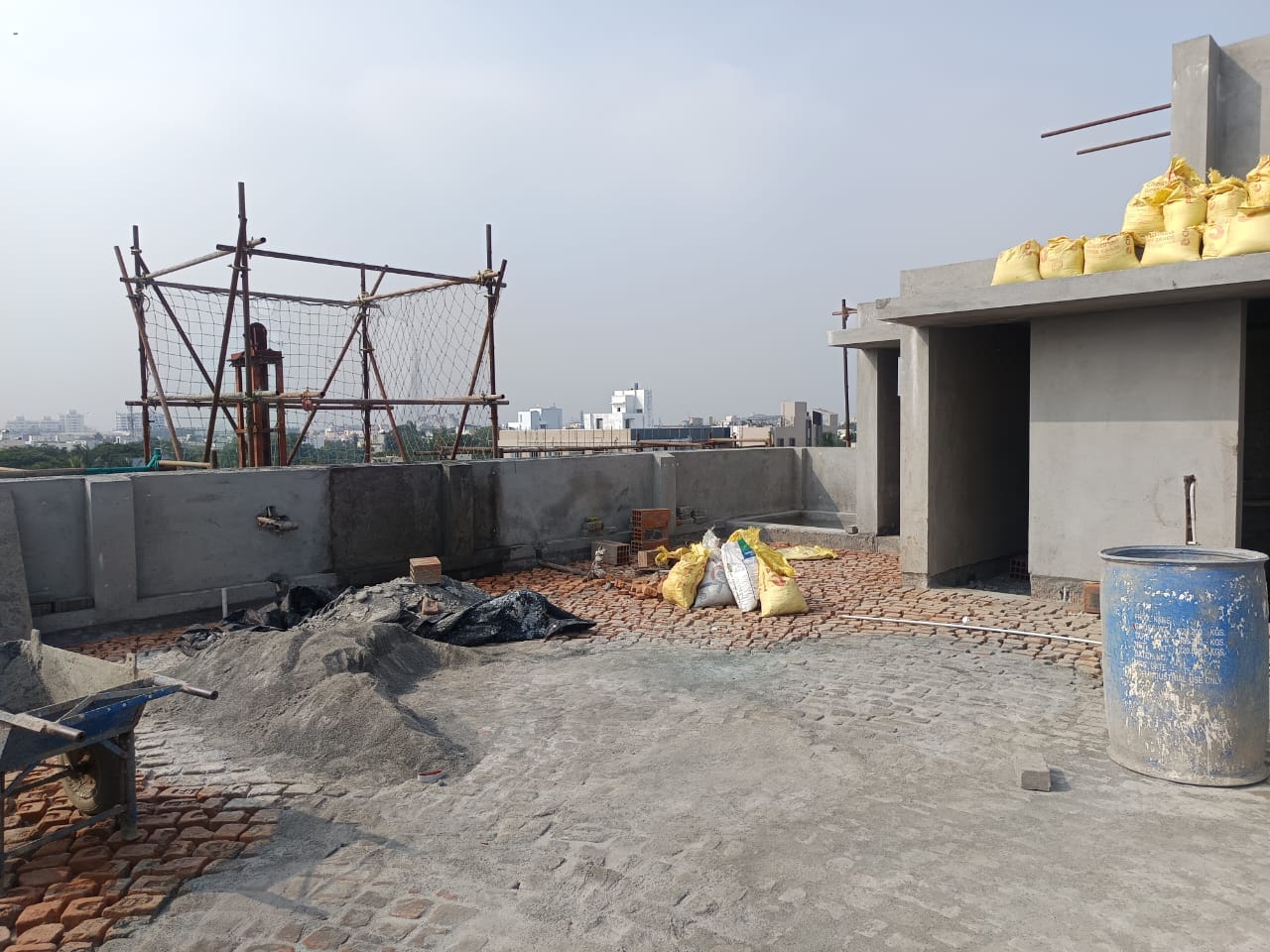

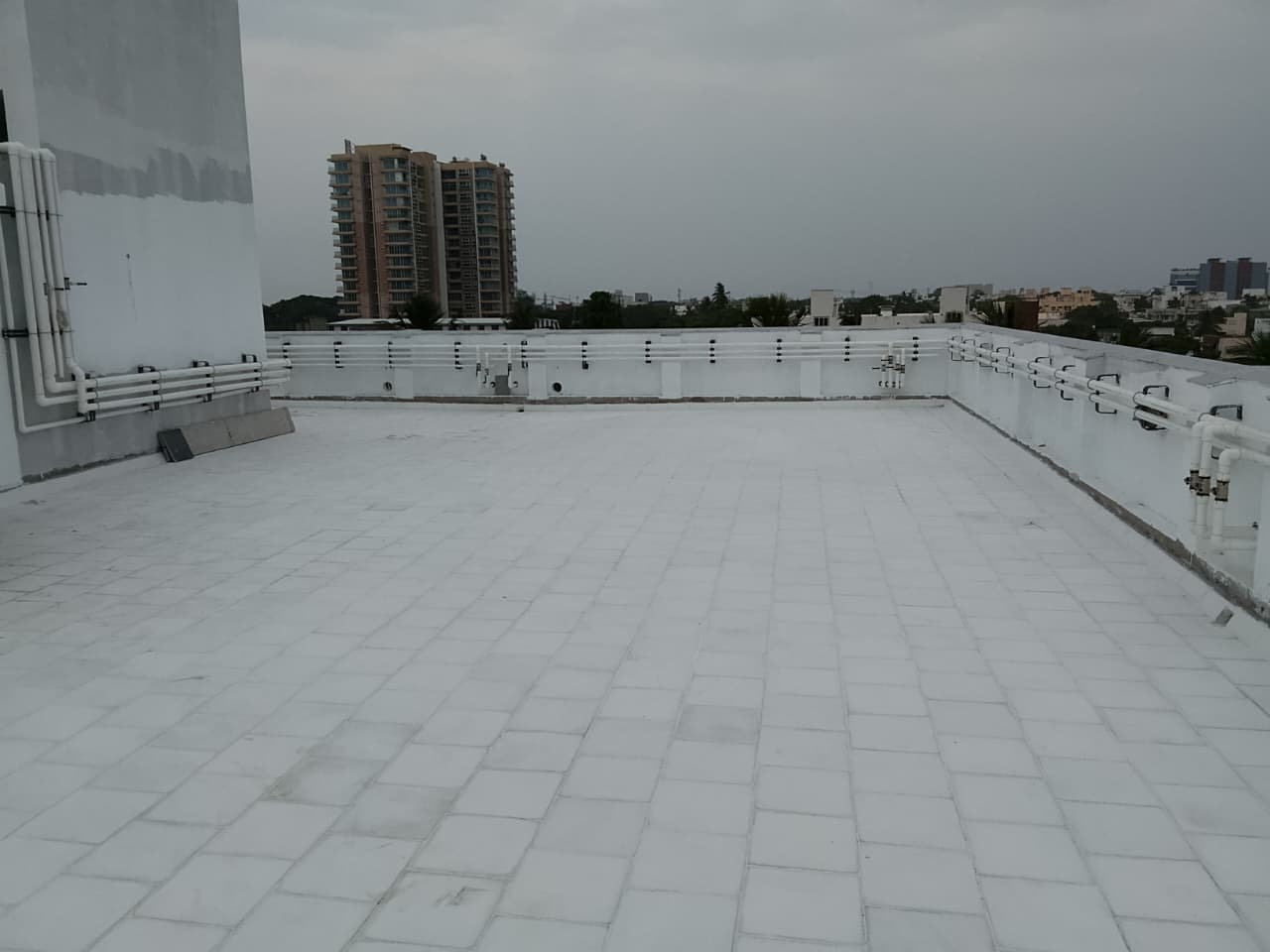

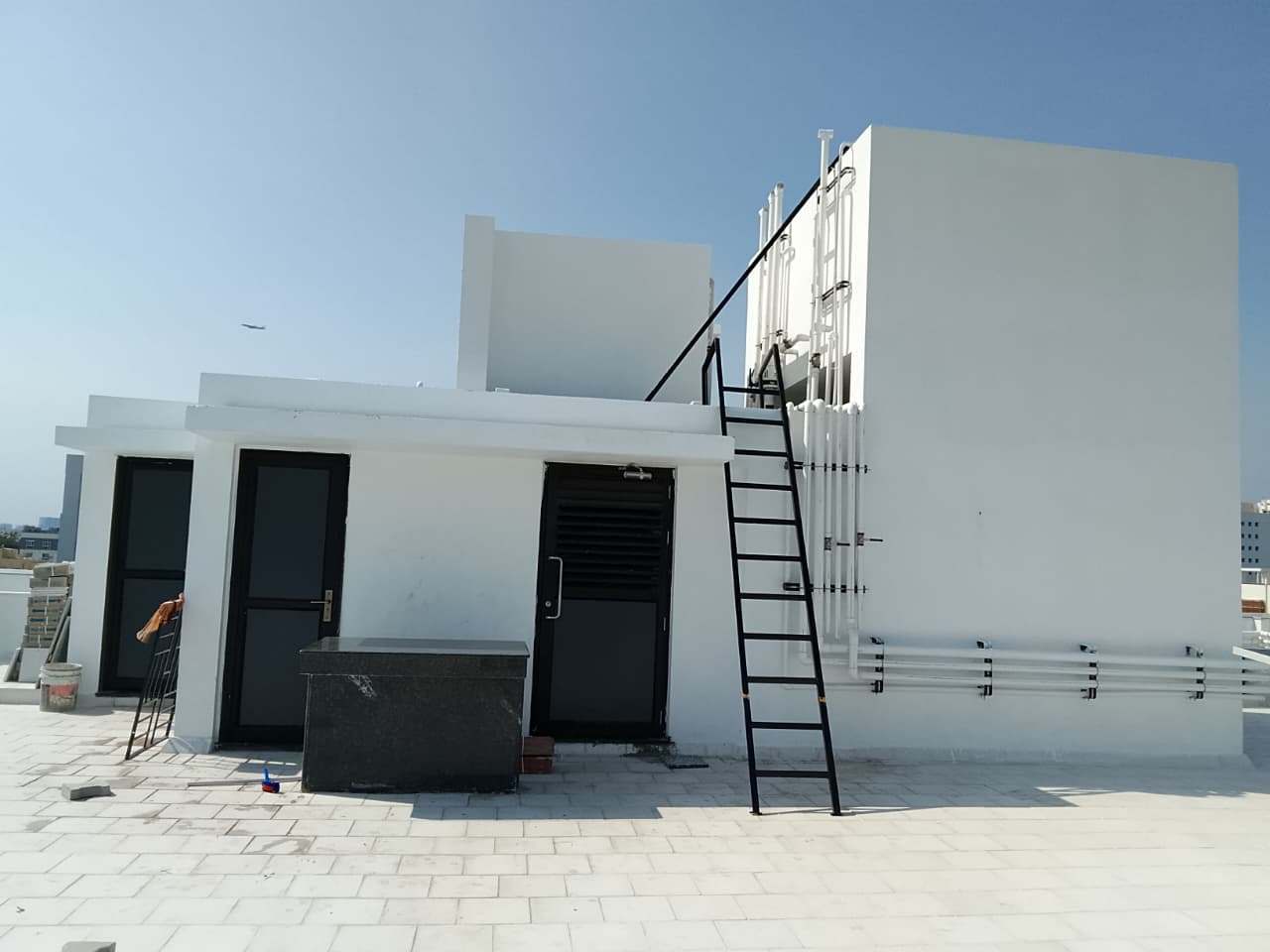

  • Terrace weathering course work is in progress.(80% completed)

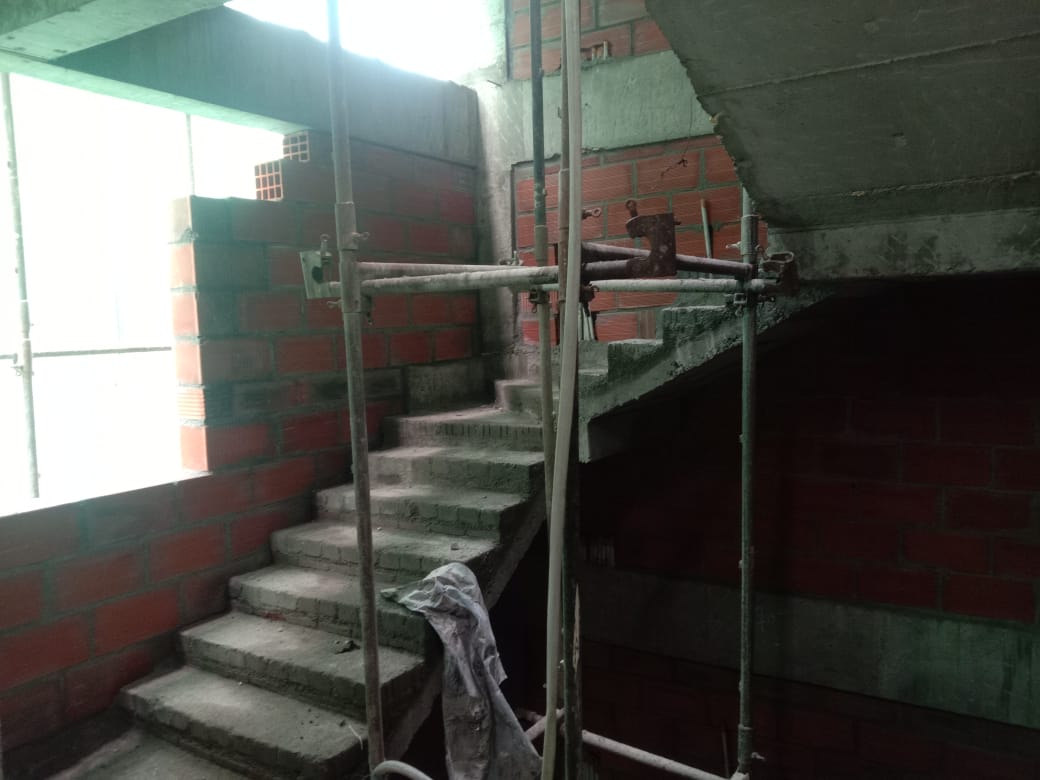

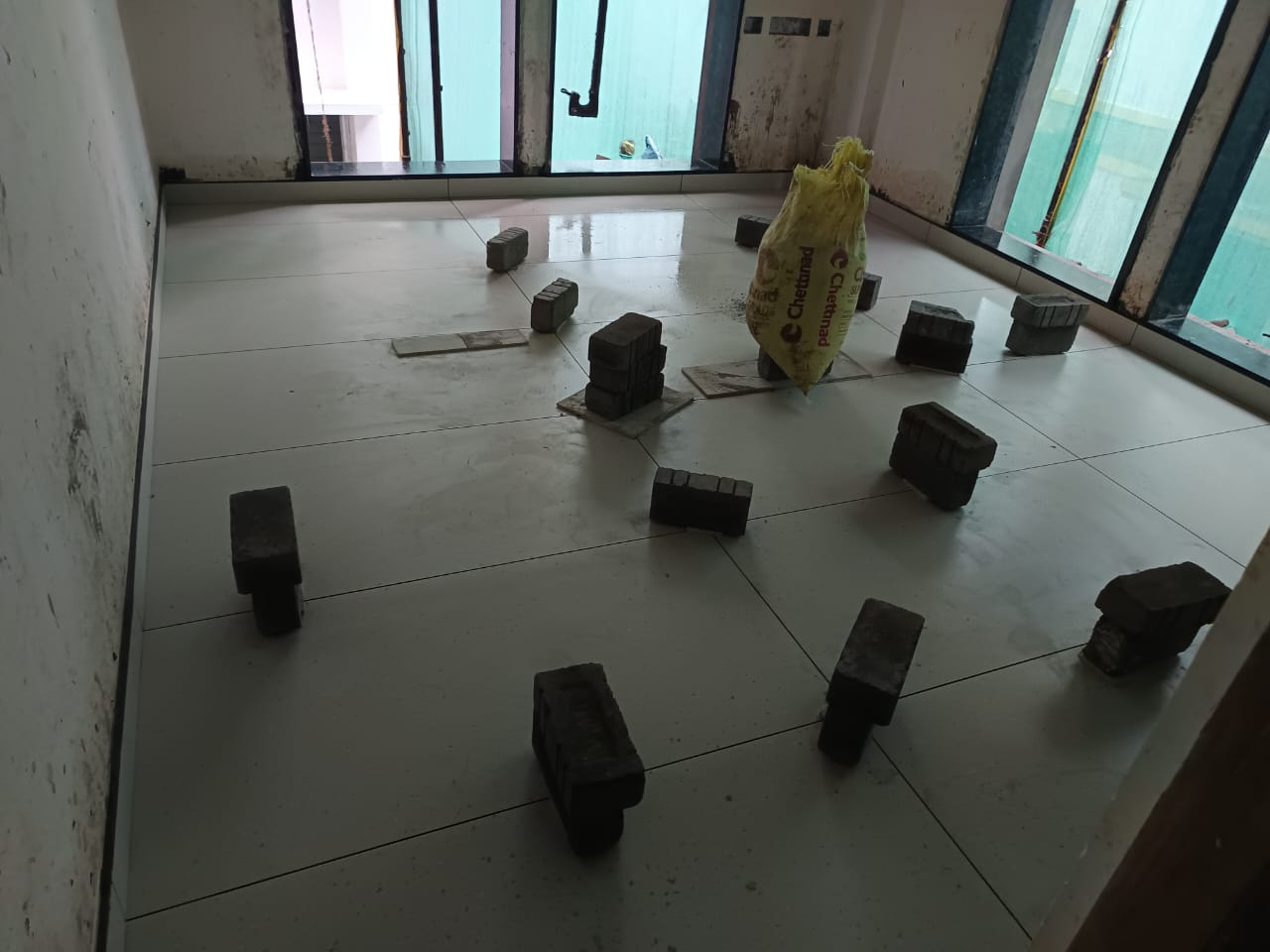

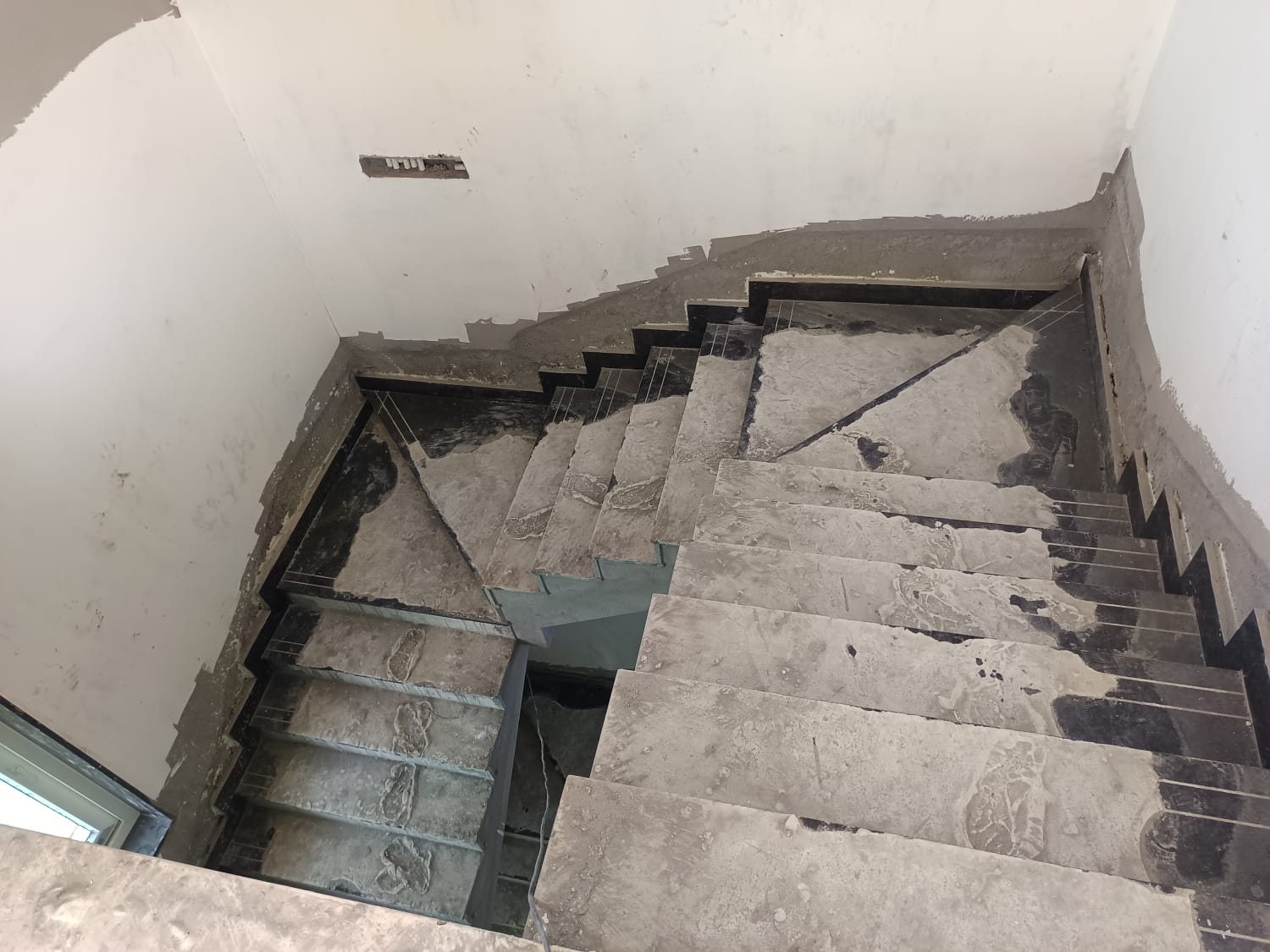

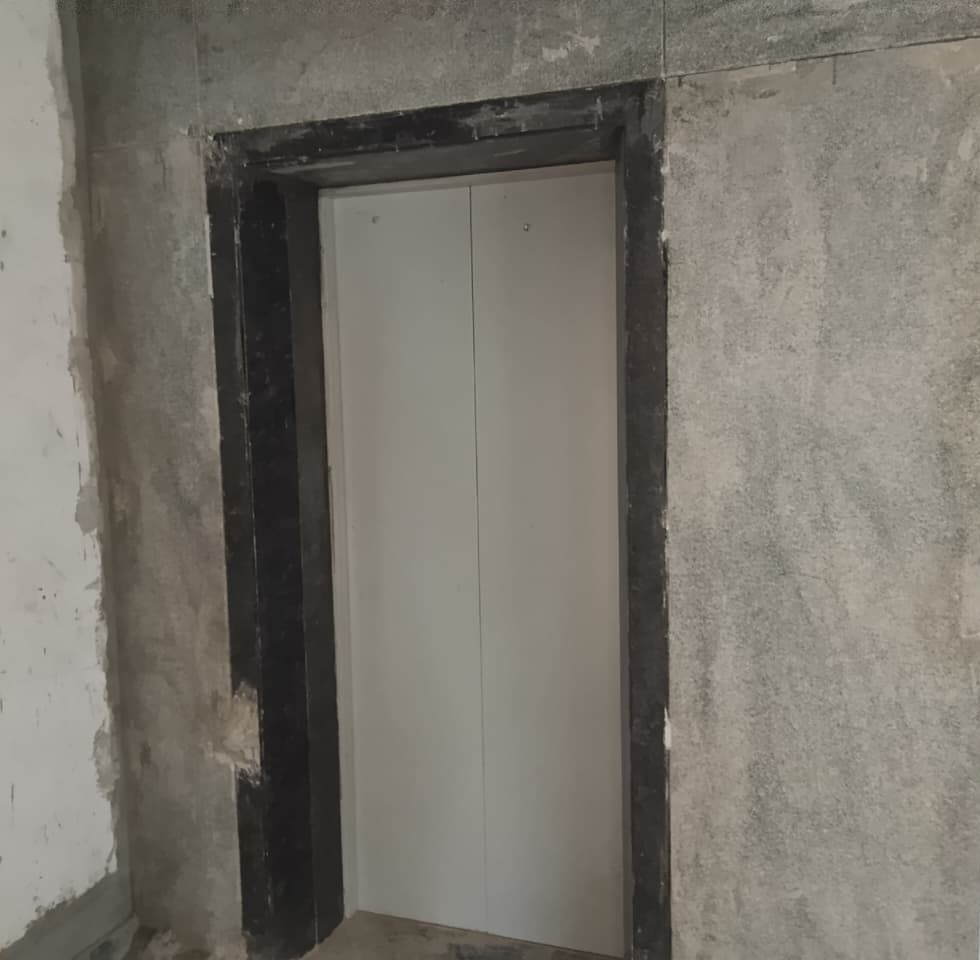

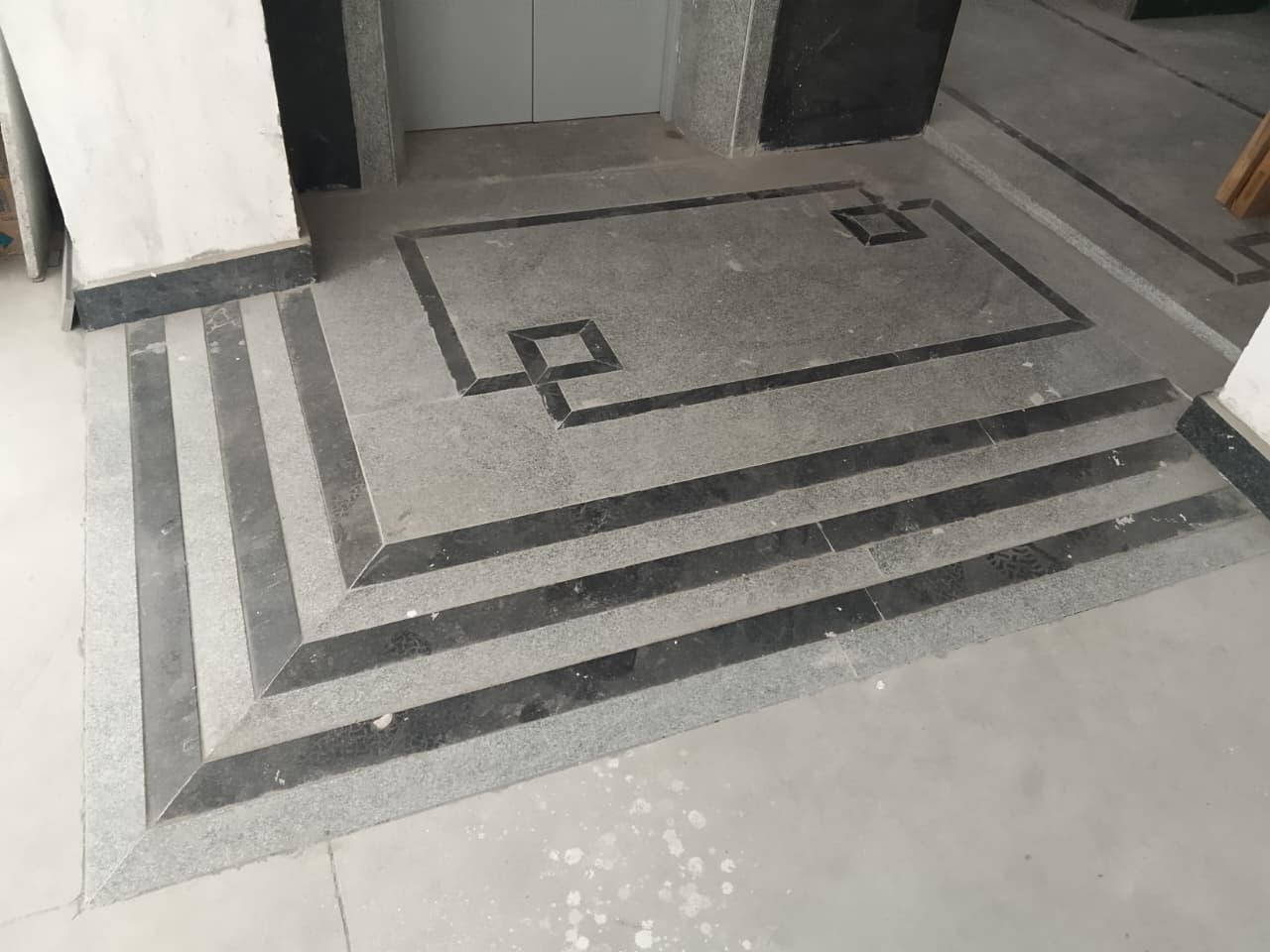

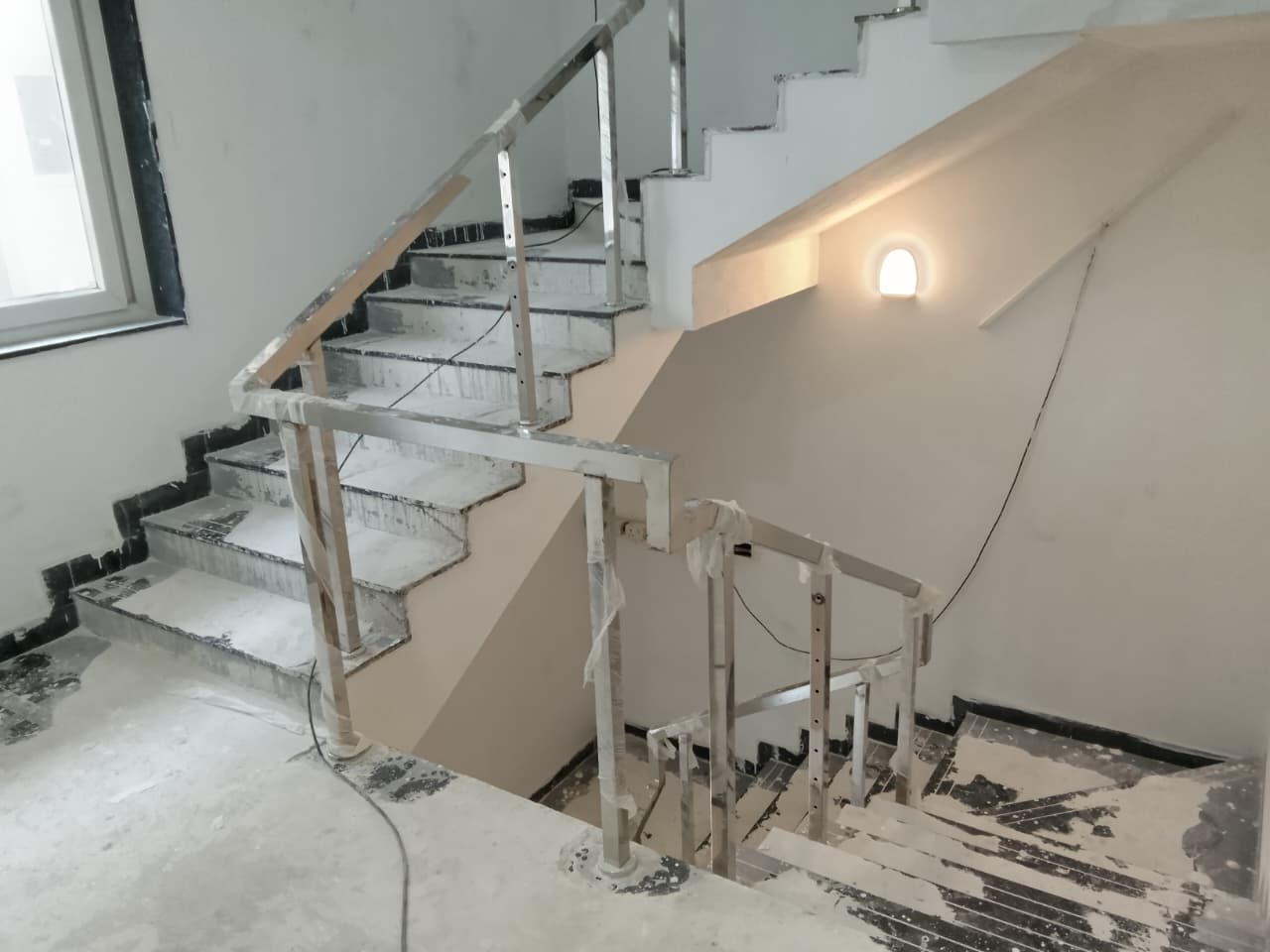

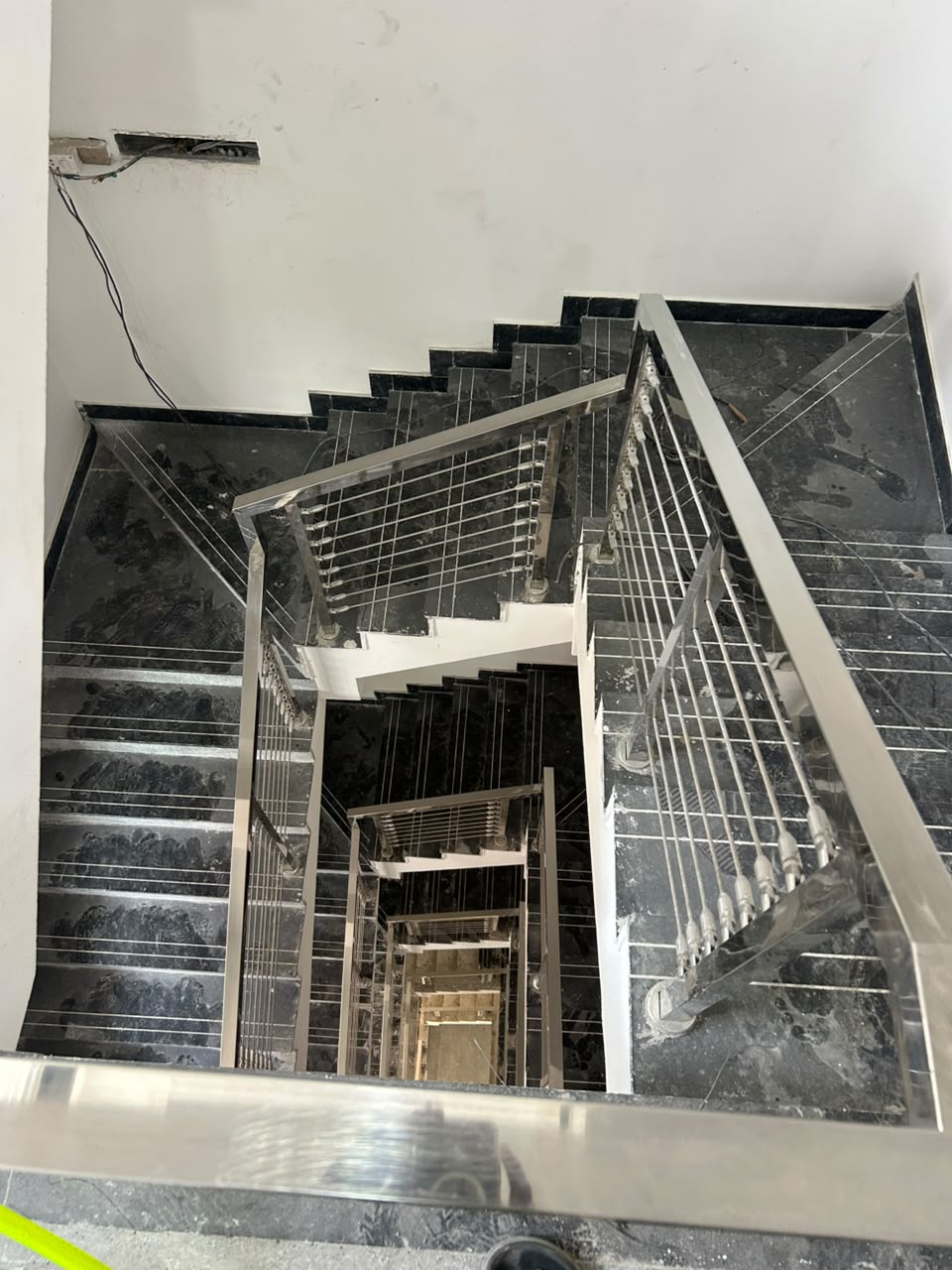

  • All floor lobby granite flooring work is in progress.

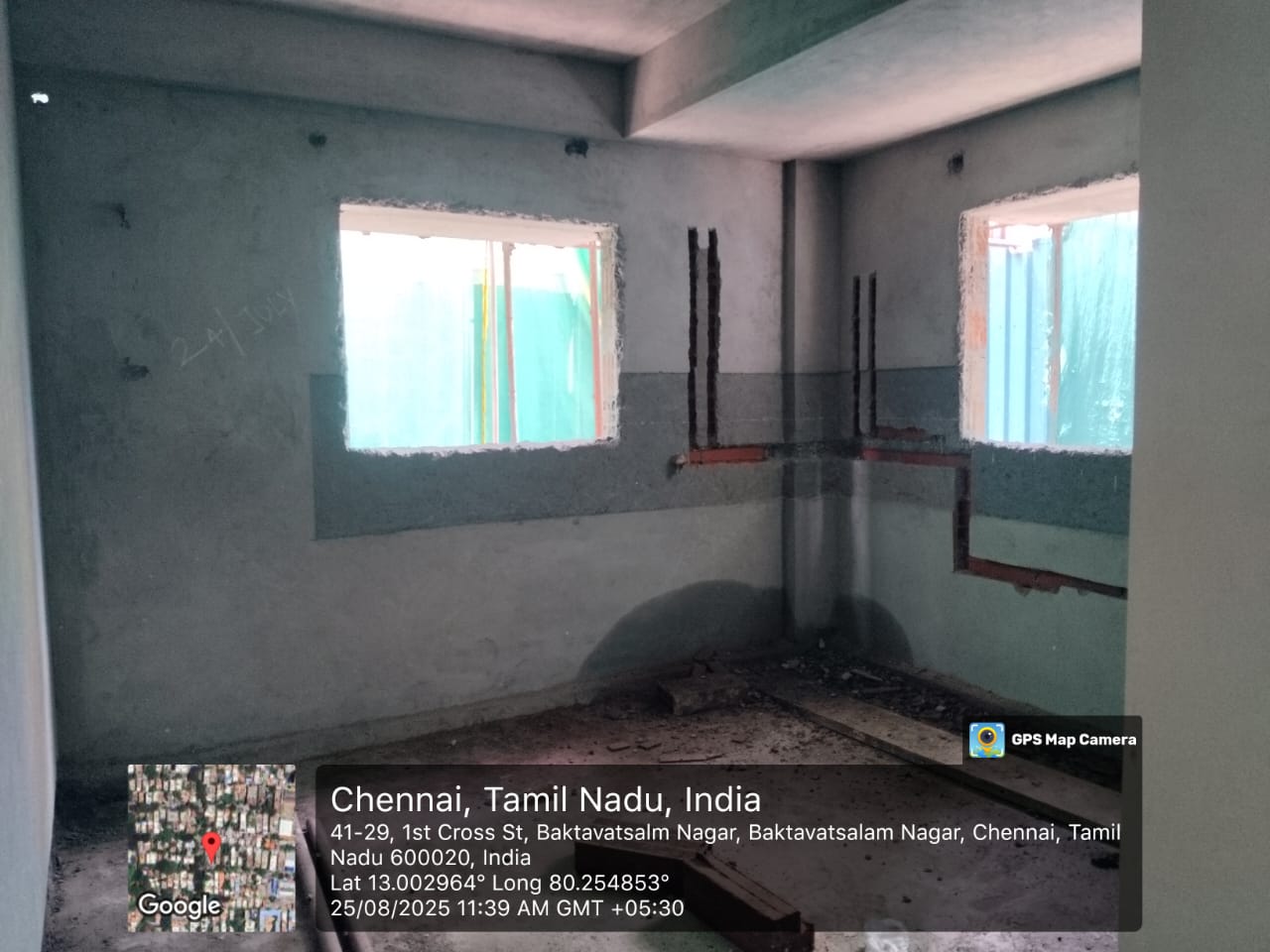

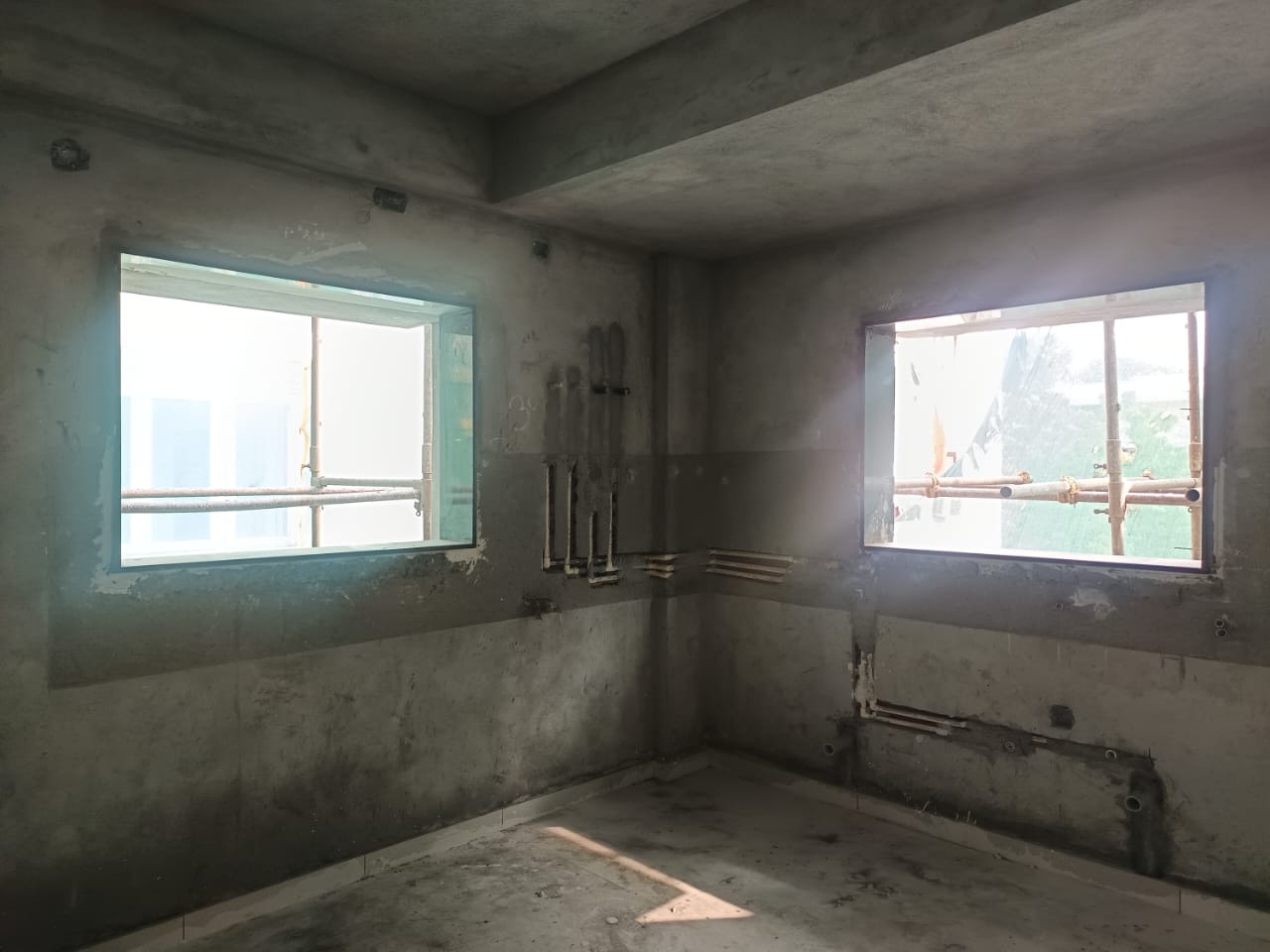

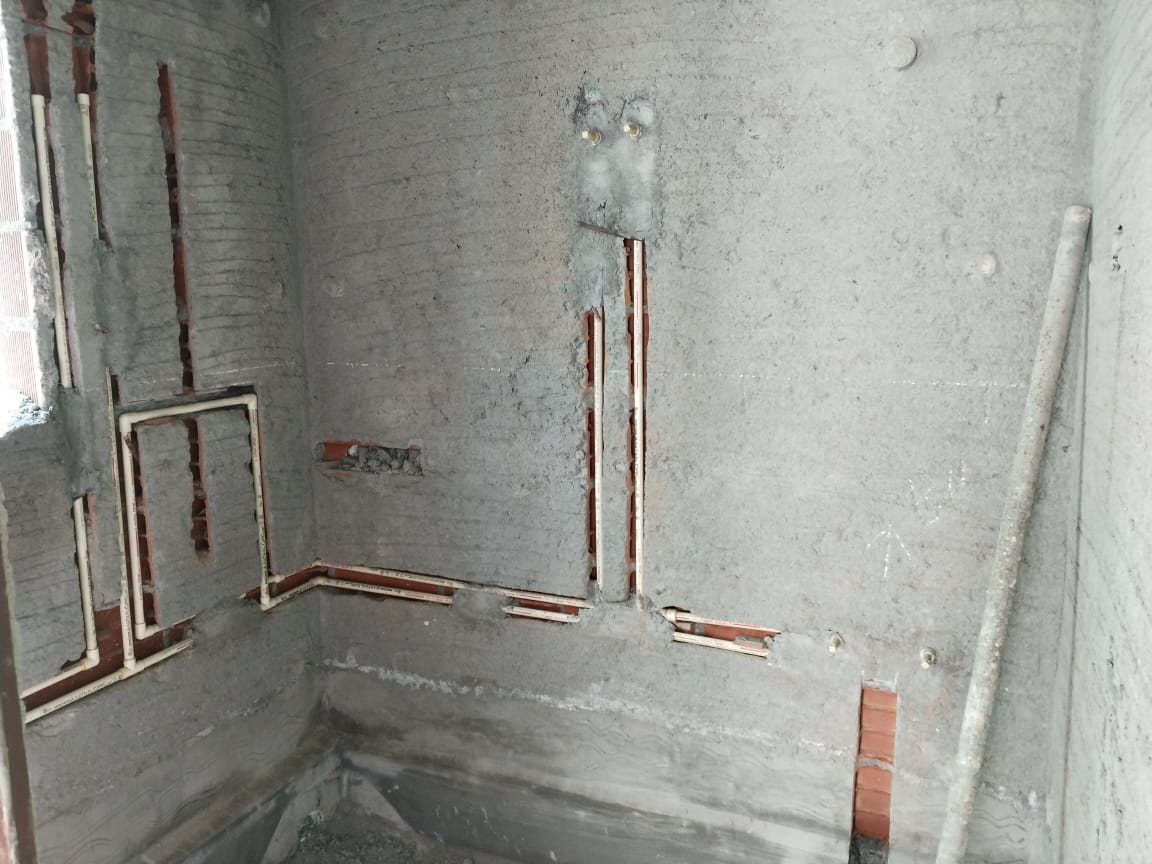

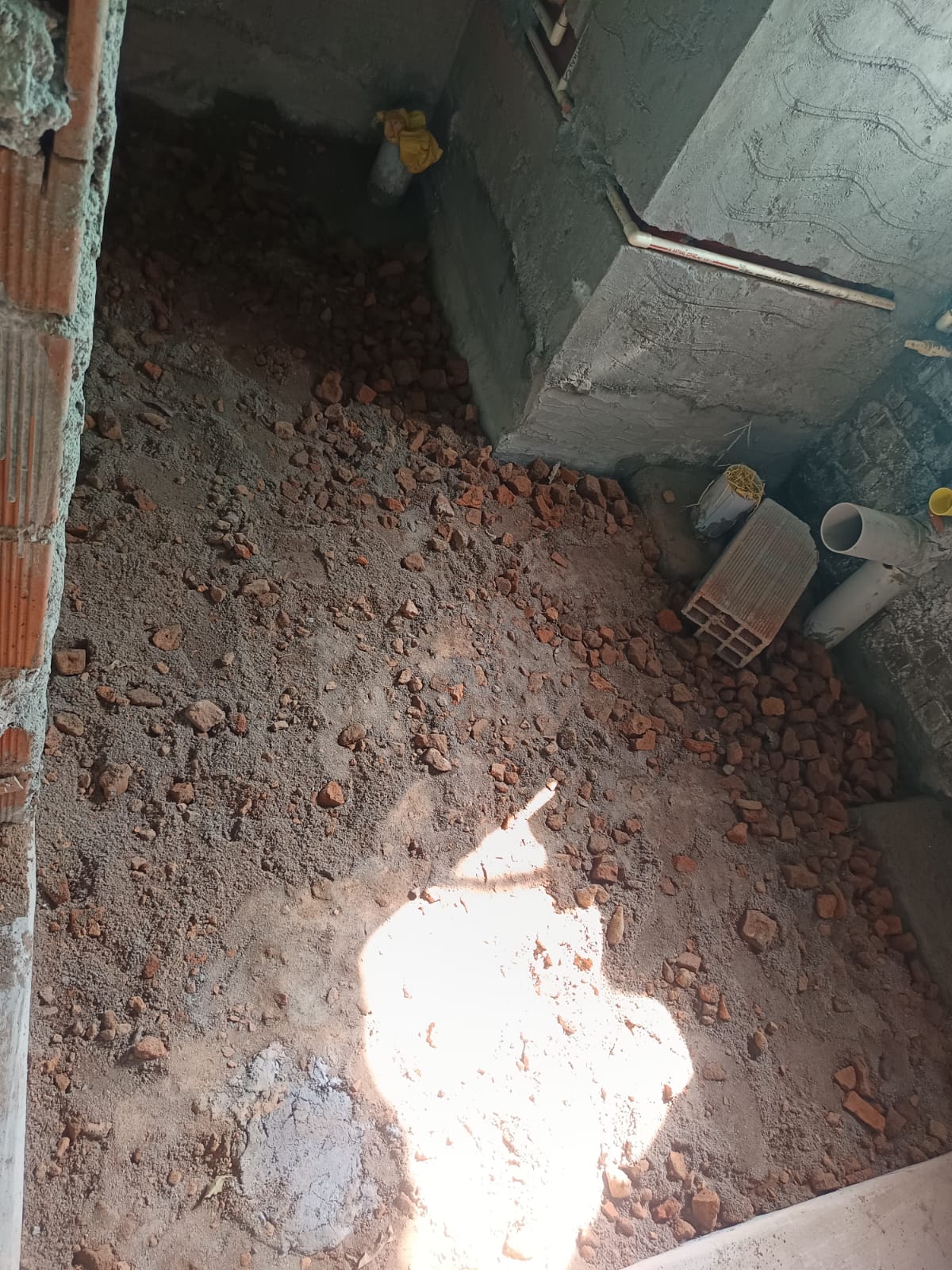

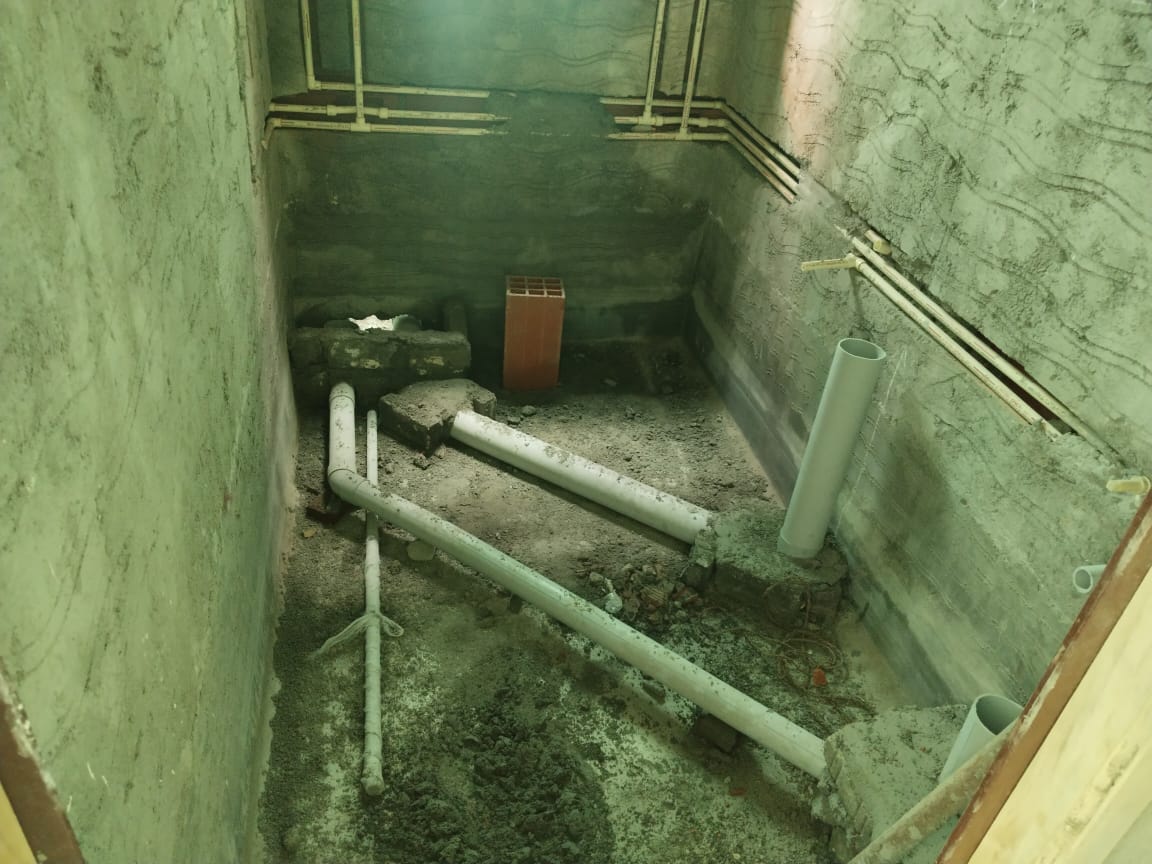

  • 5th floor toilet plumbing work is in progress.(Up to 4th floor completed)
  • General flooring work is completed.(1st and 2nd floor completed)

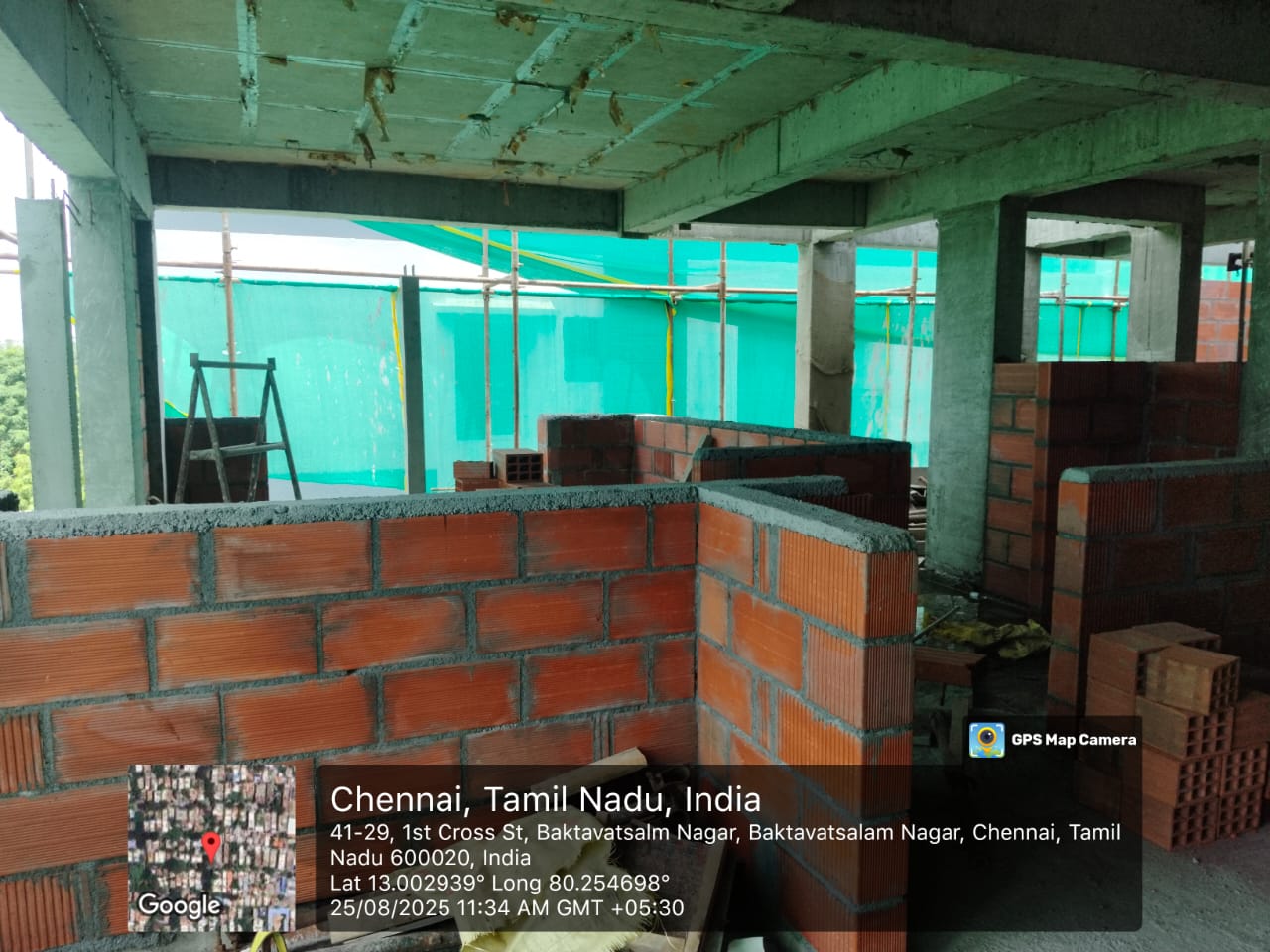

  • Elevation wall cladding tiles work is in progress.(75% completed)
  • Toilet wall tiles work is in progress.(1stand 2nd floor completed)

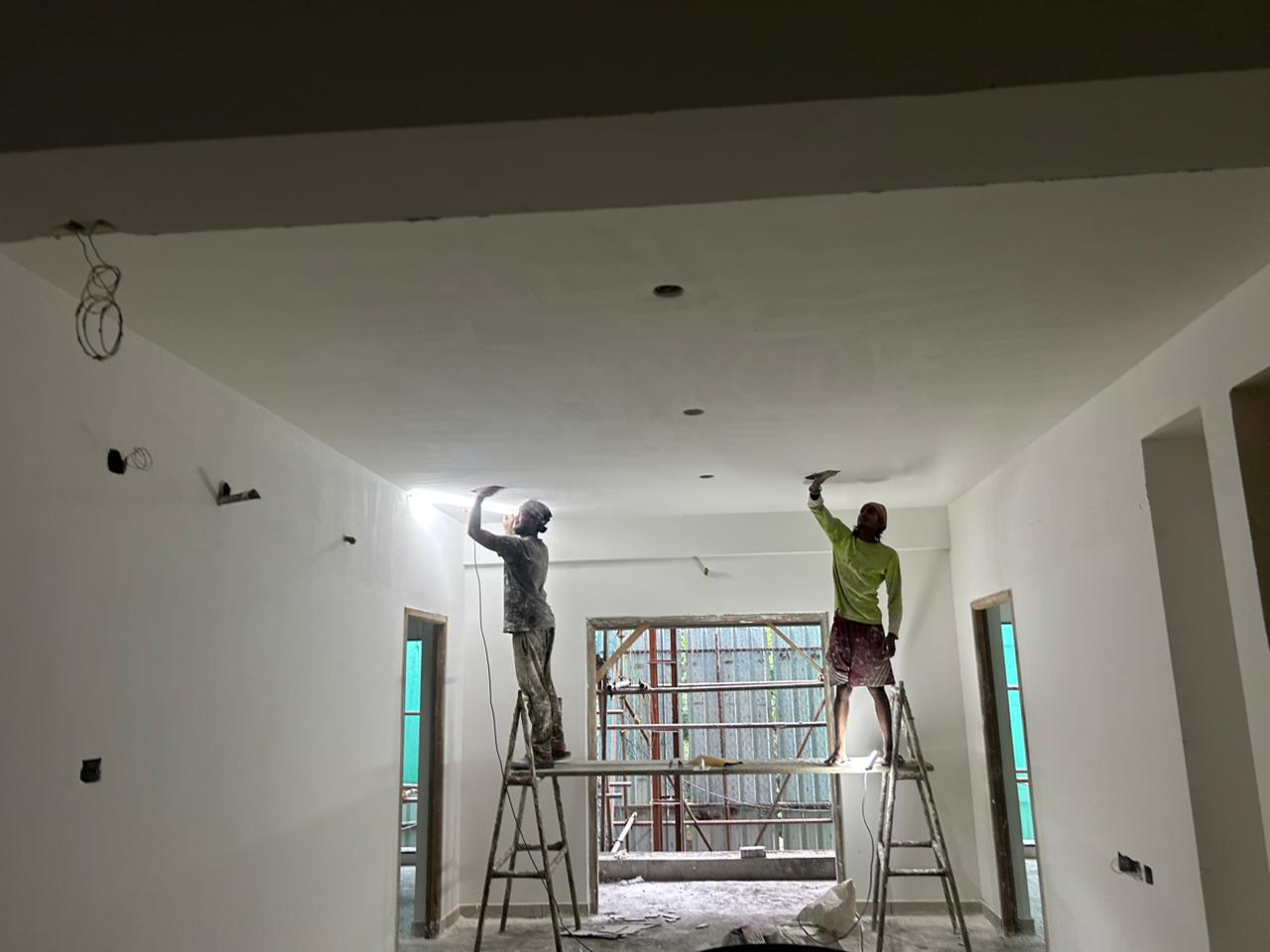

  • Texture painting work is in progress.(90% completed)
  • Terrace weathering course work is in progress.(95% completed)

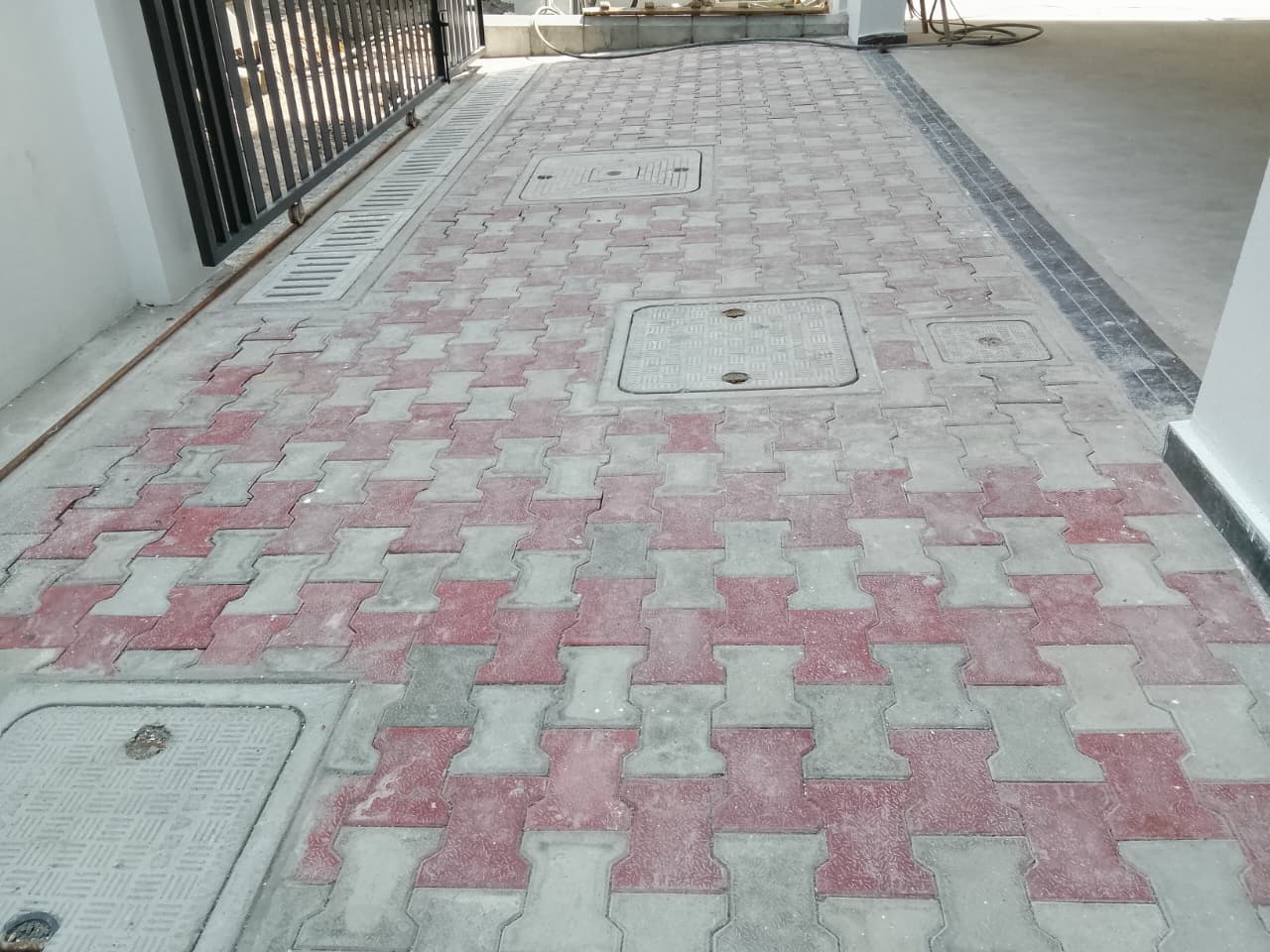

  • All floor lobby & staircase granite flooring work is in progress.(60% completed)

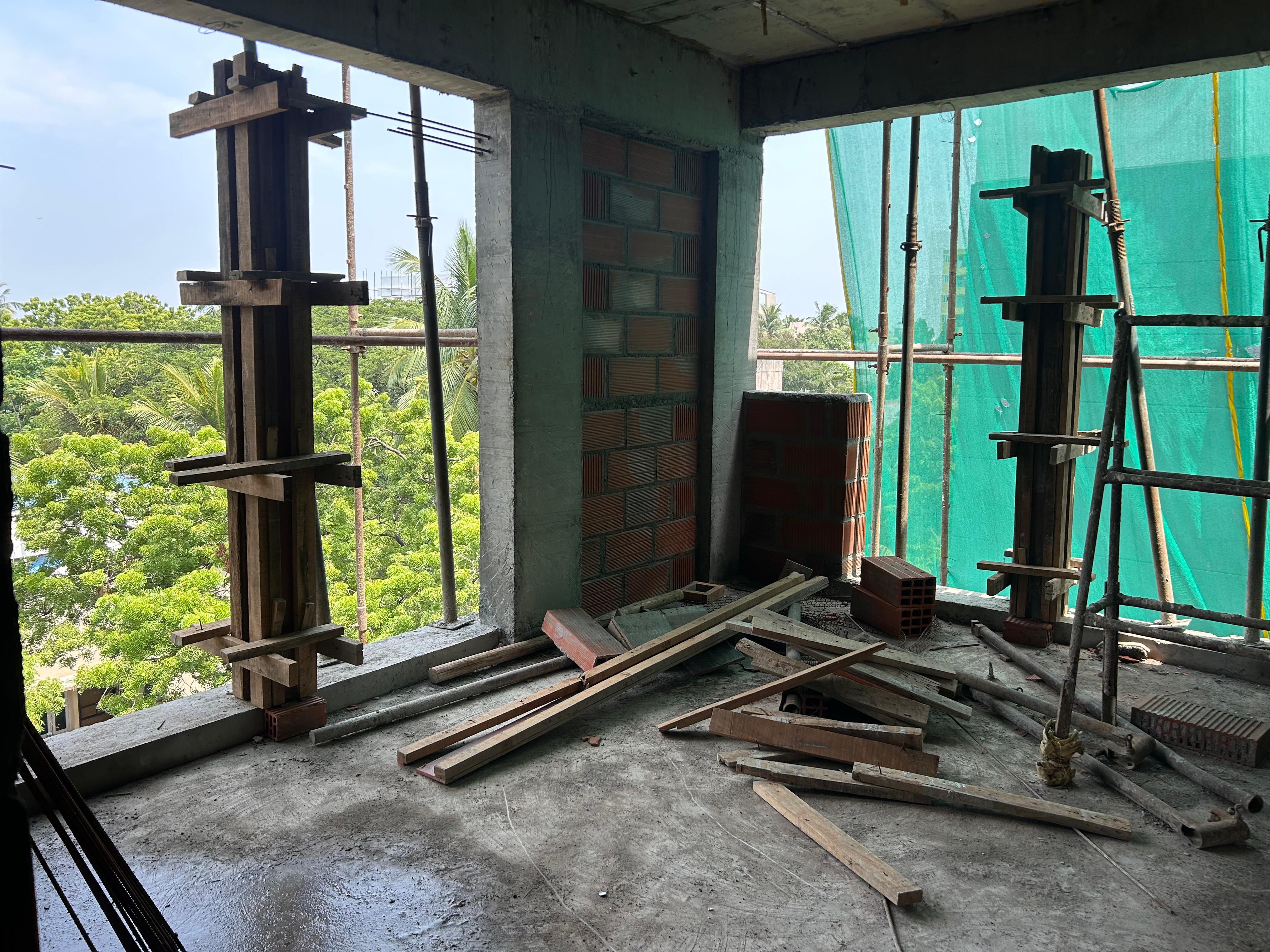

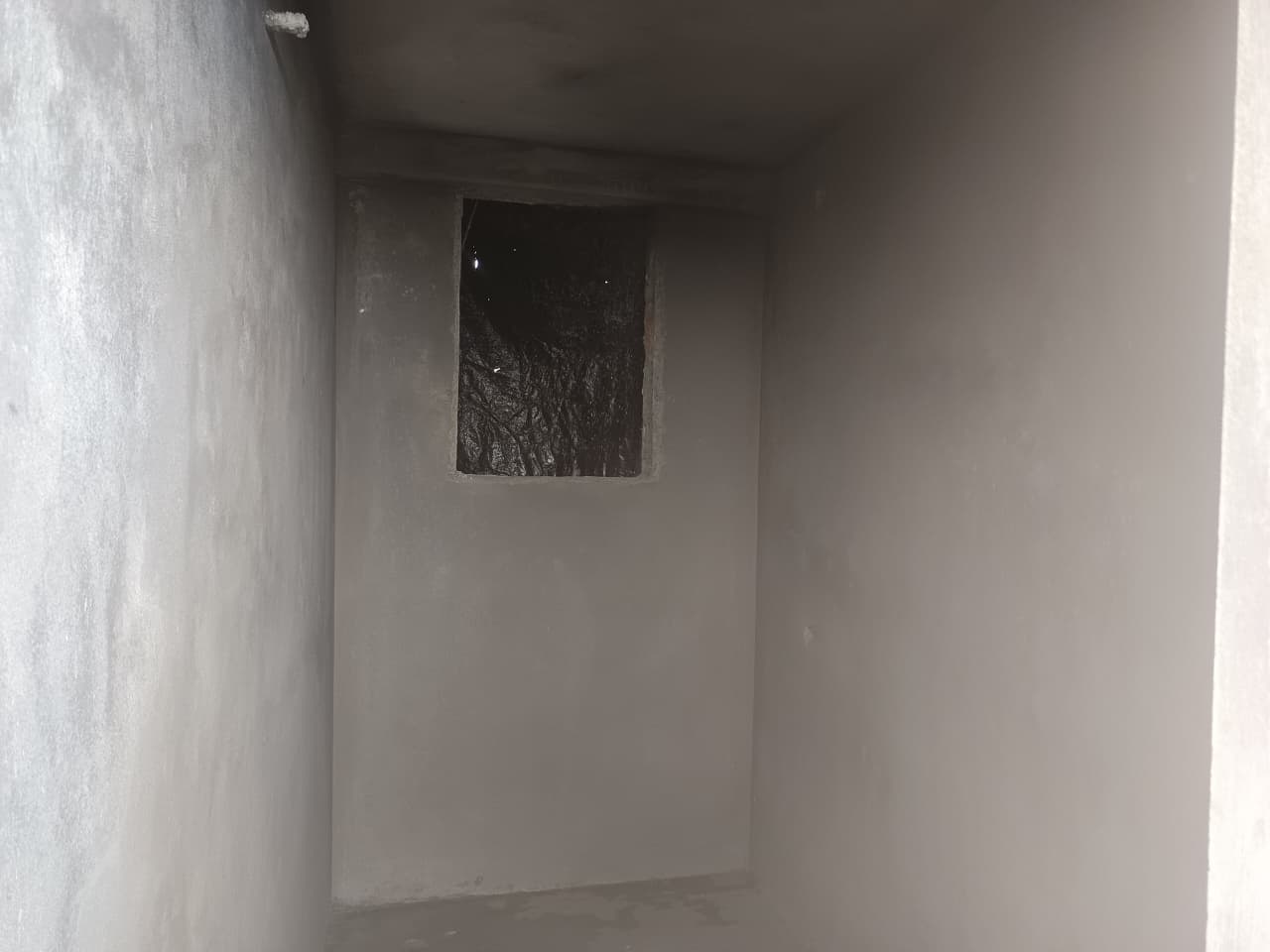

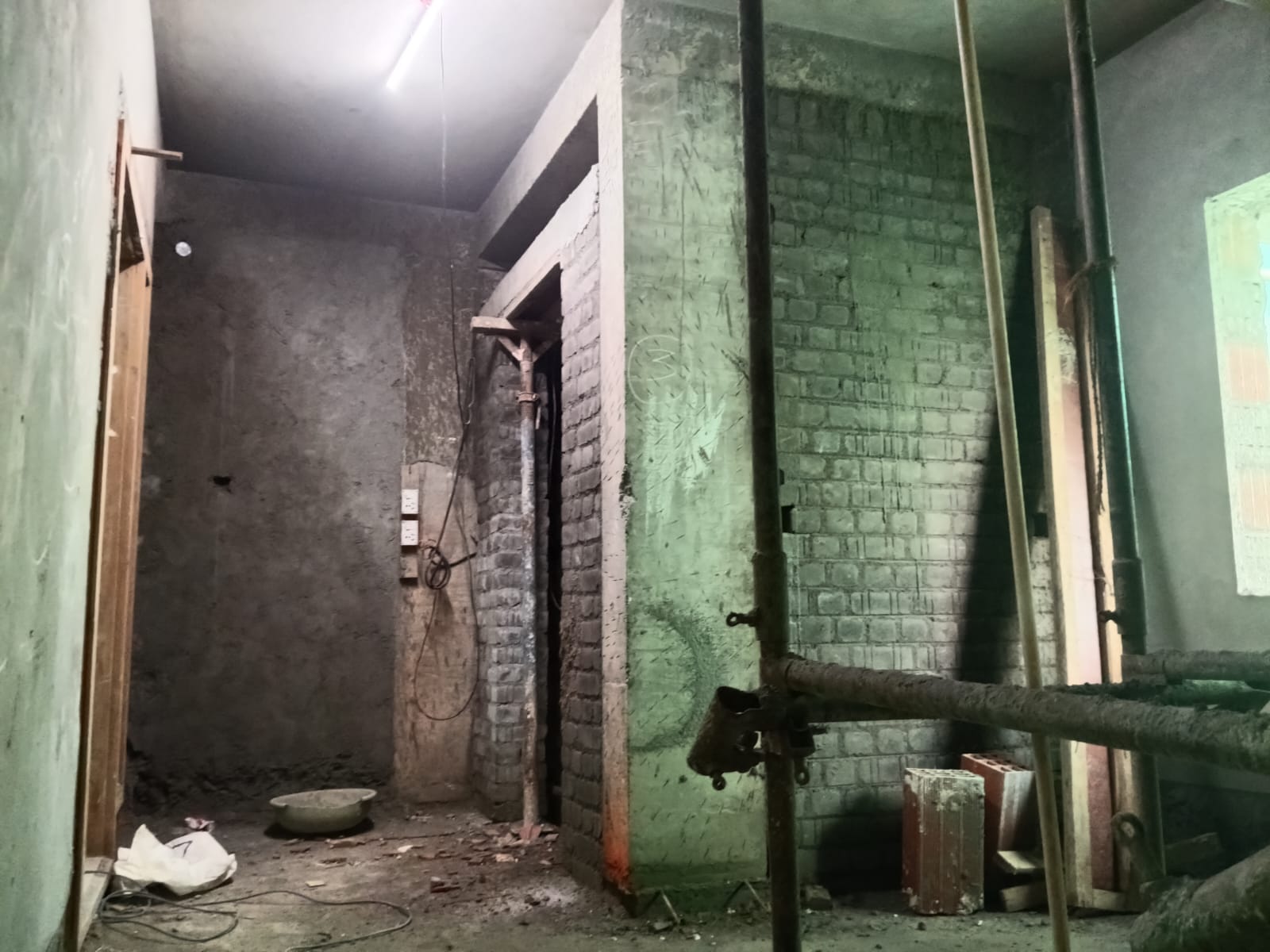

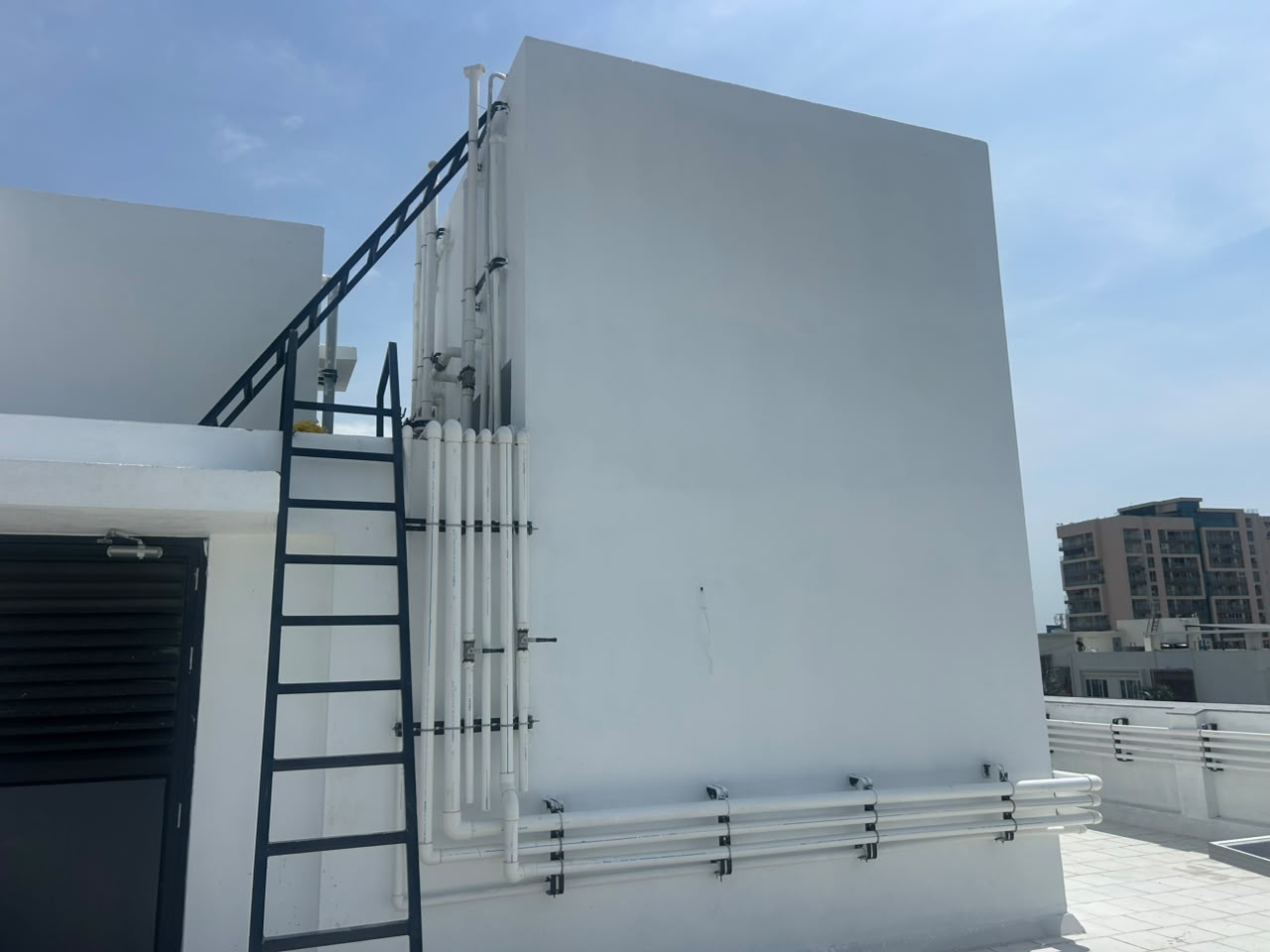

  • Duct plumbing work is in progress.
  • 5th floor toilet plumbing work is in progress.(Up to 4th floor completed)
  • General flooring work is completed.(1st and 2nd floor completed)
  • Elevation wall cladding tiles work is in progress.(80% completed)

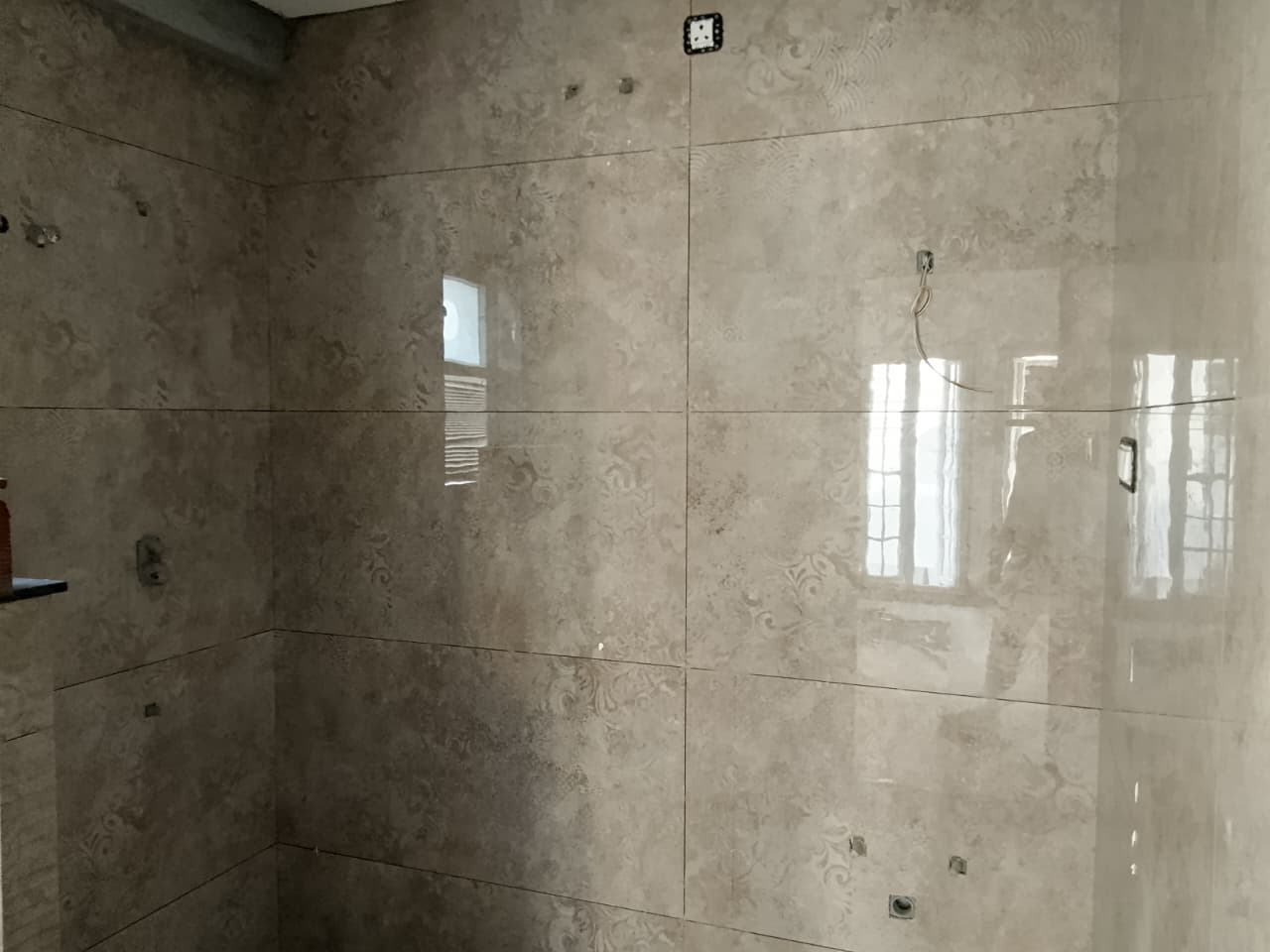

  • Toilet wall tiles work is in progress.(1stand 2nd floor completed)
  • Texture painting work is in progress.(90% completed)
  • Terrace weathering course work is in progress.(95% completed)

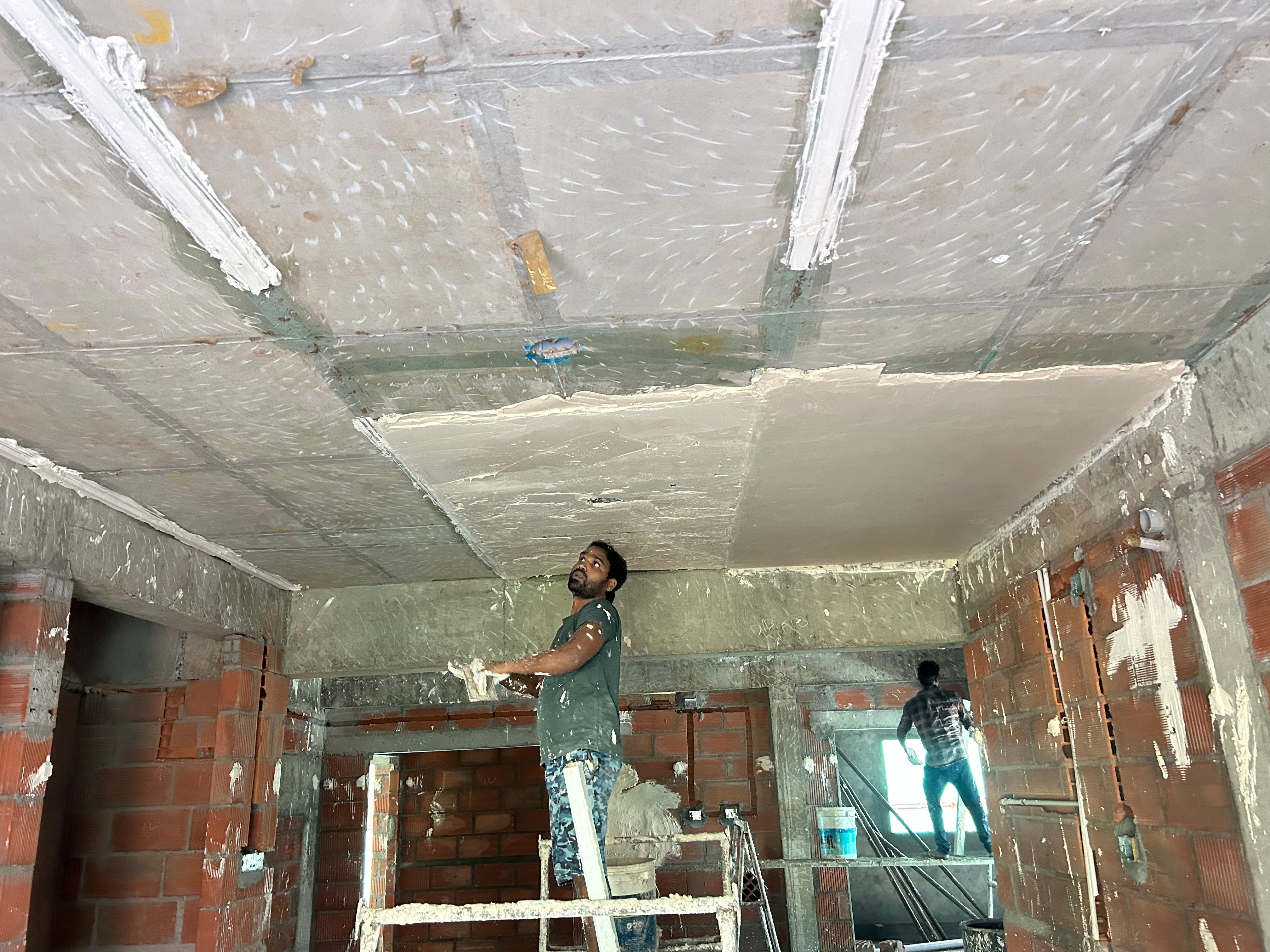

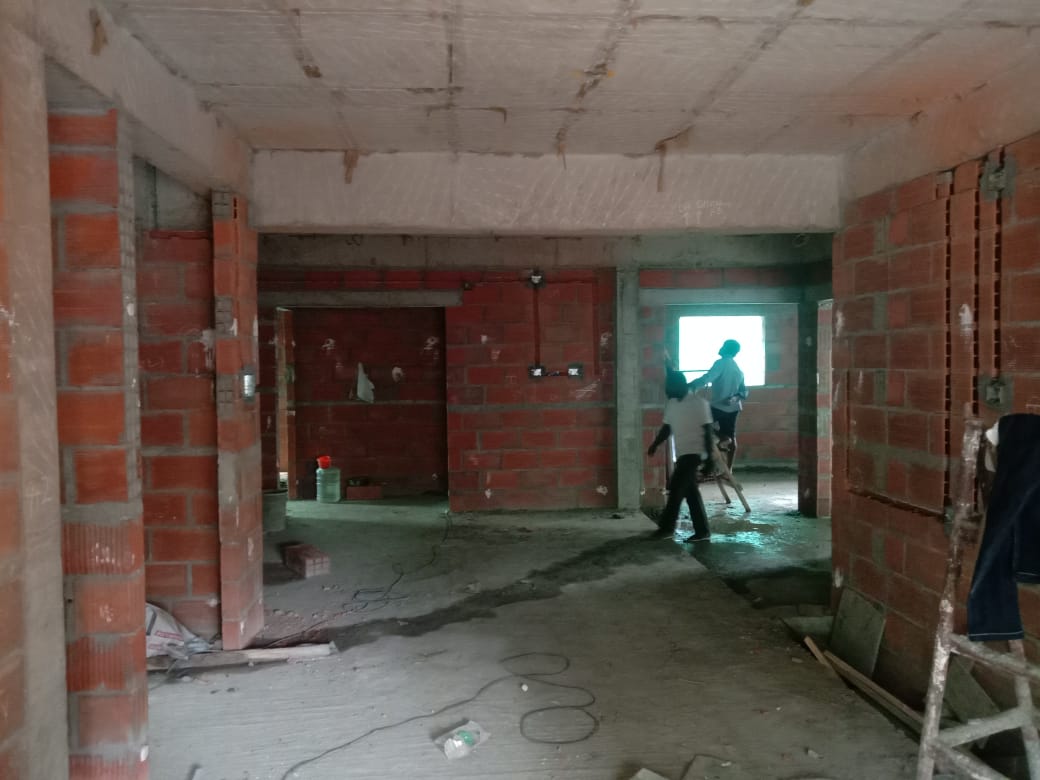

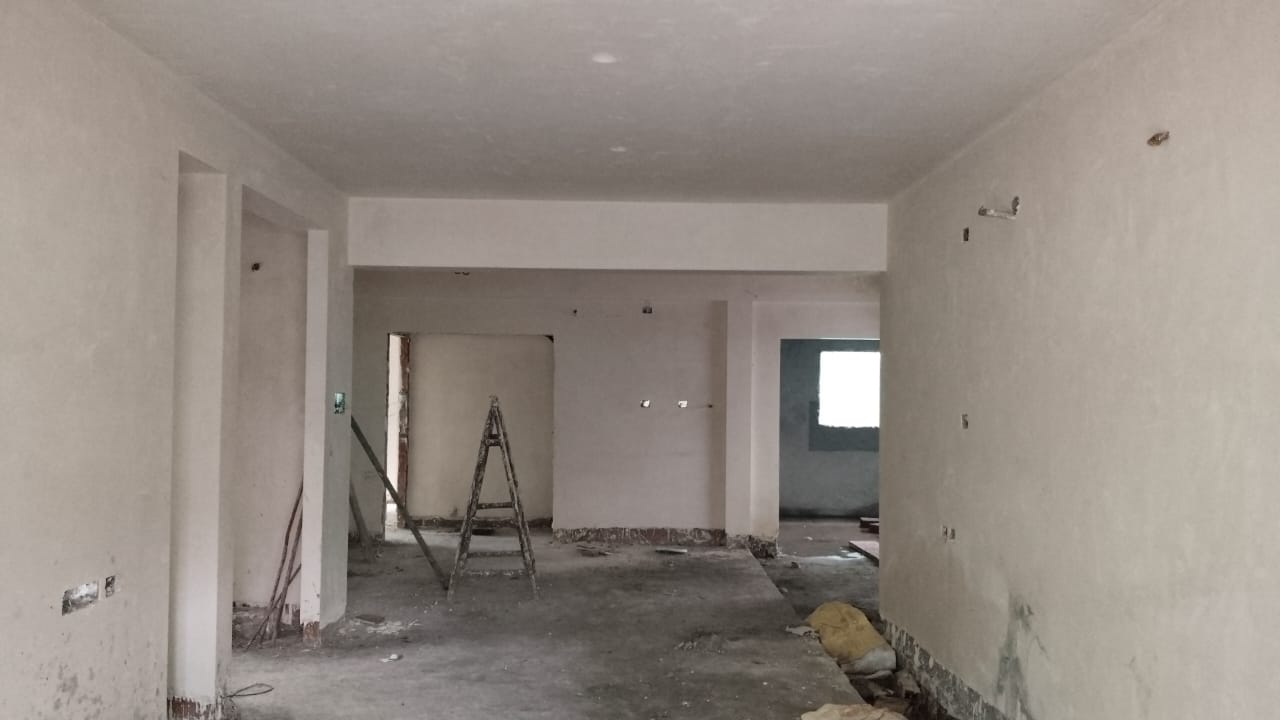

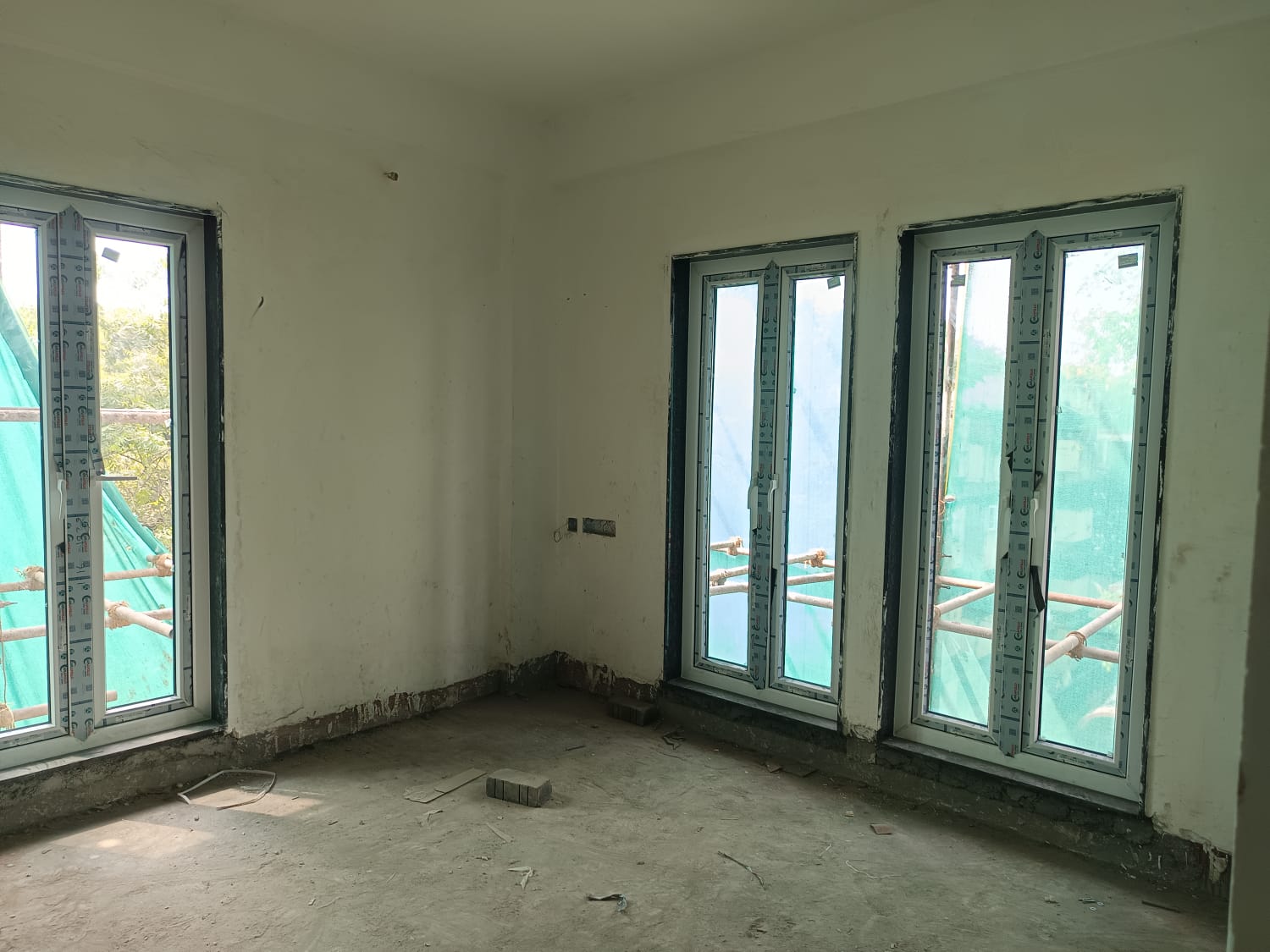

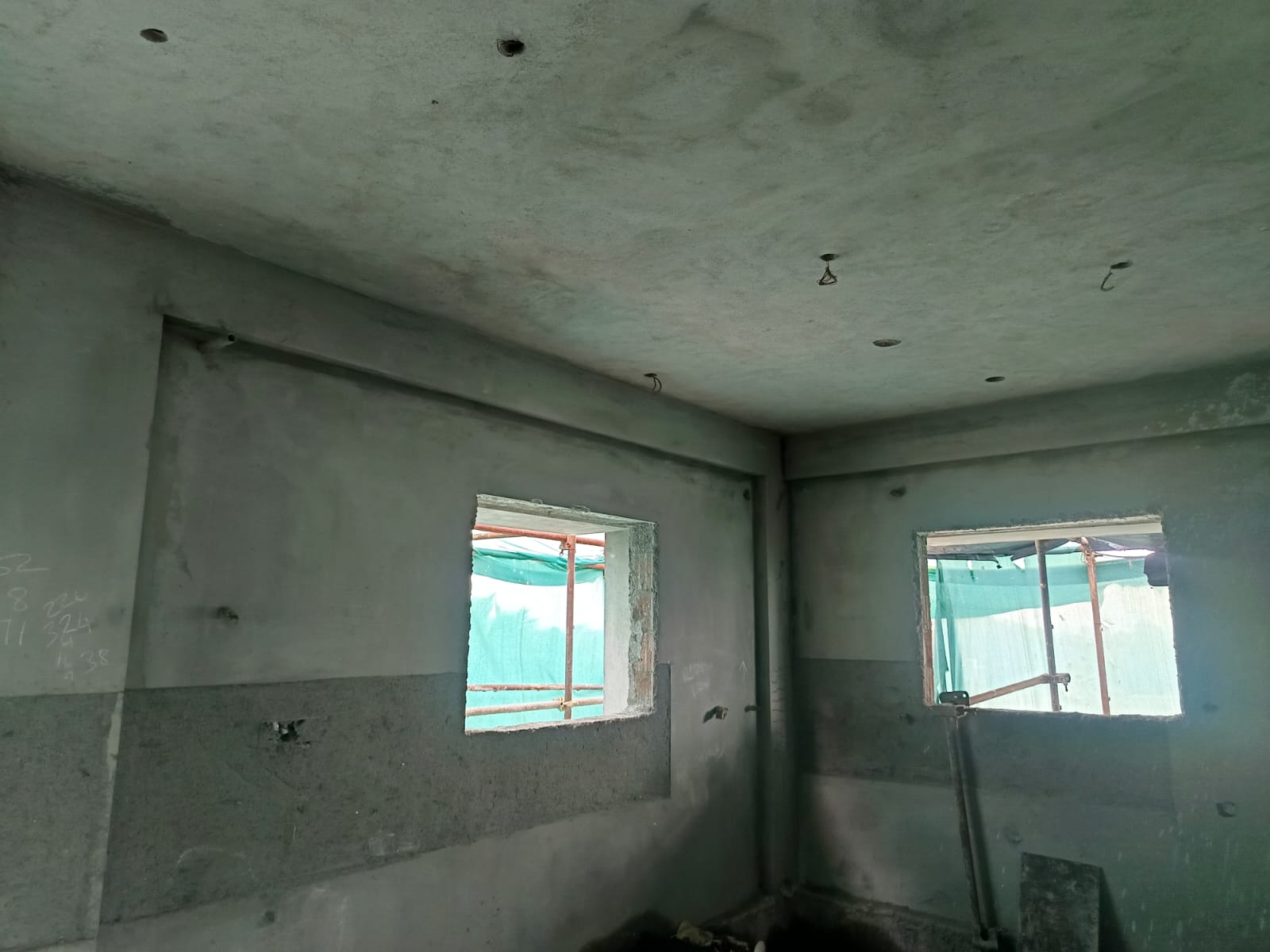

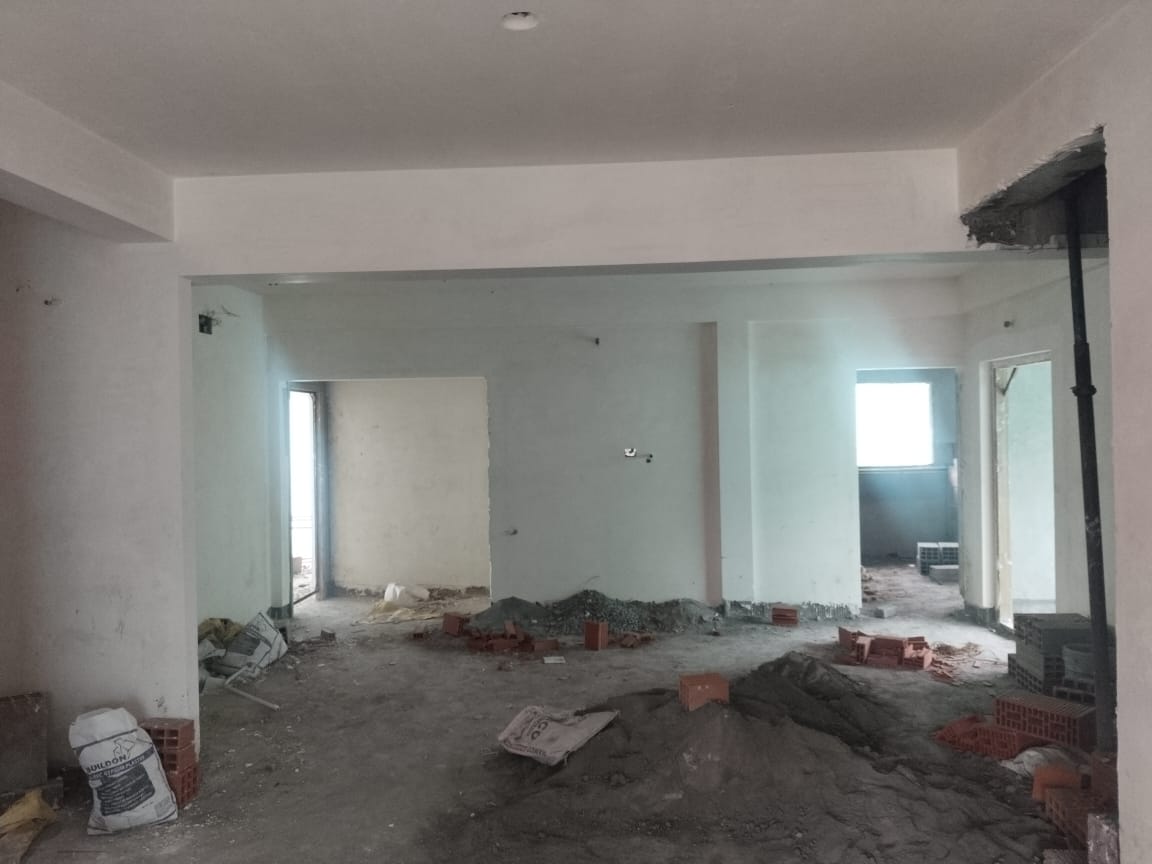

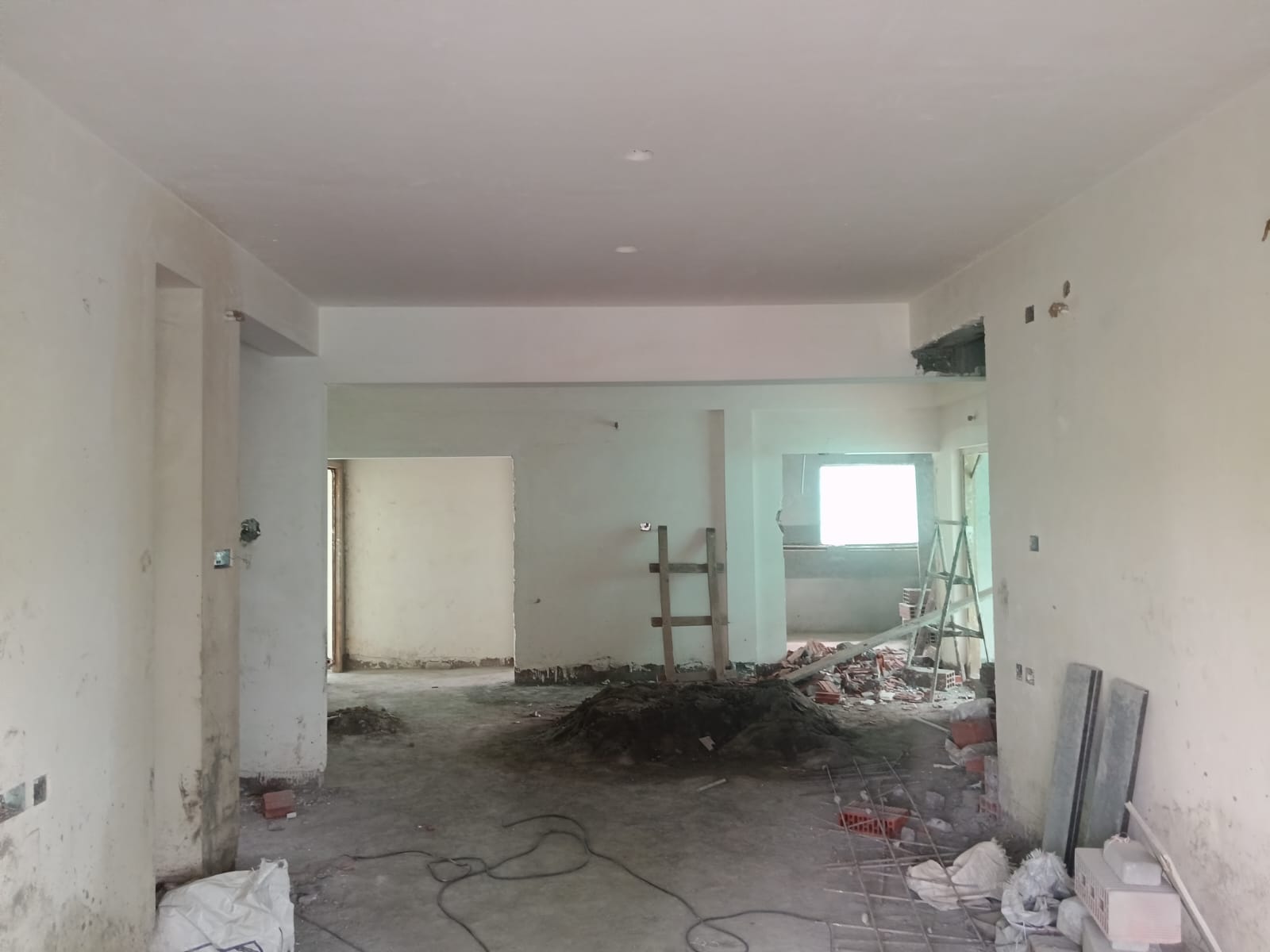

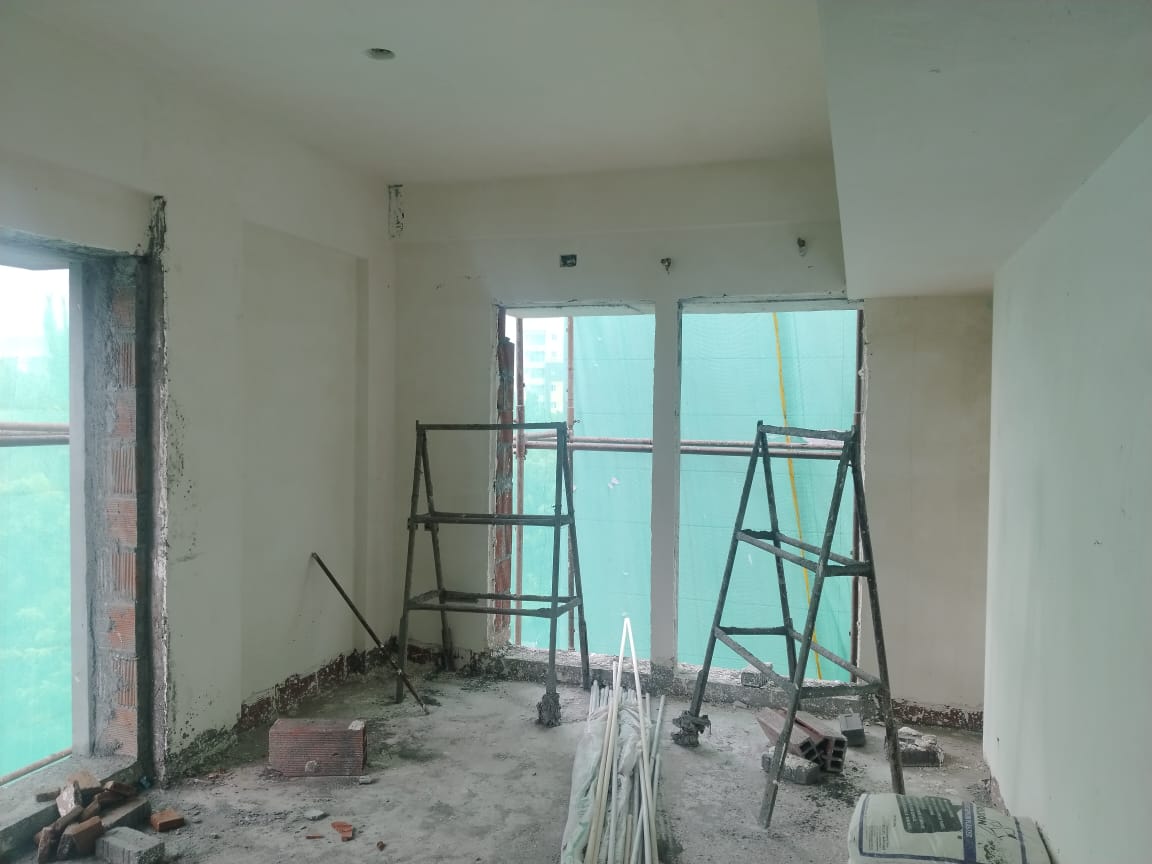

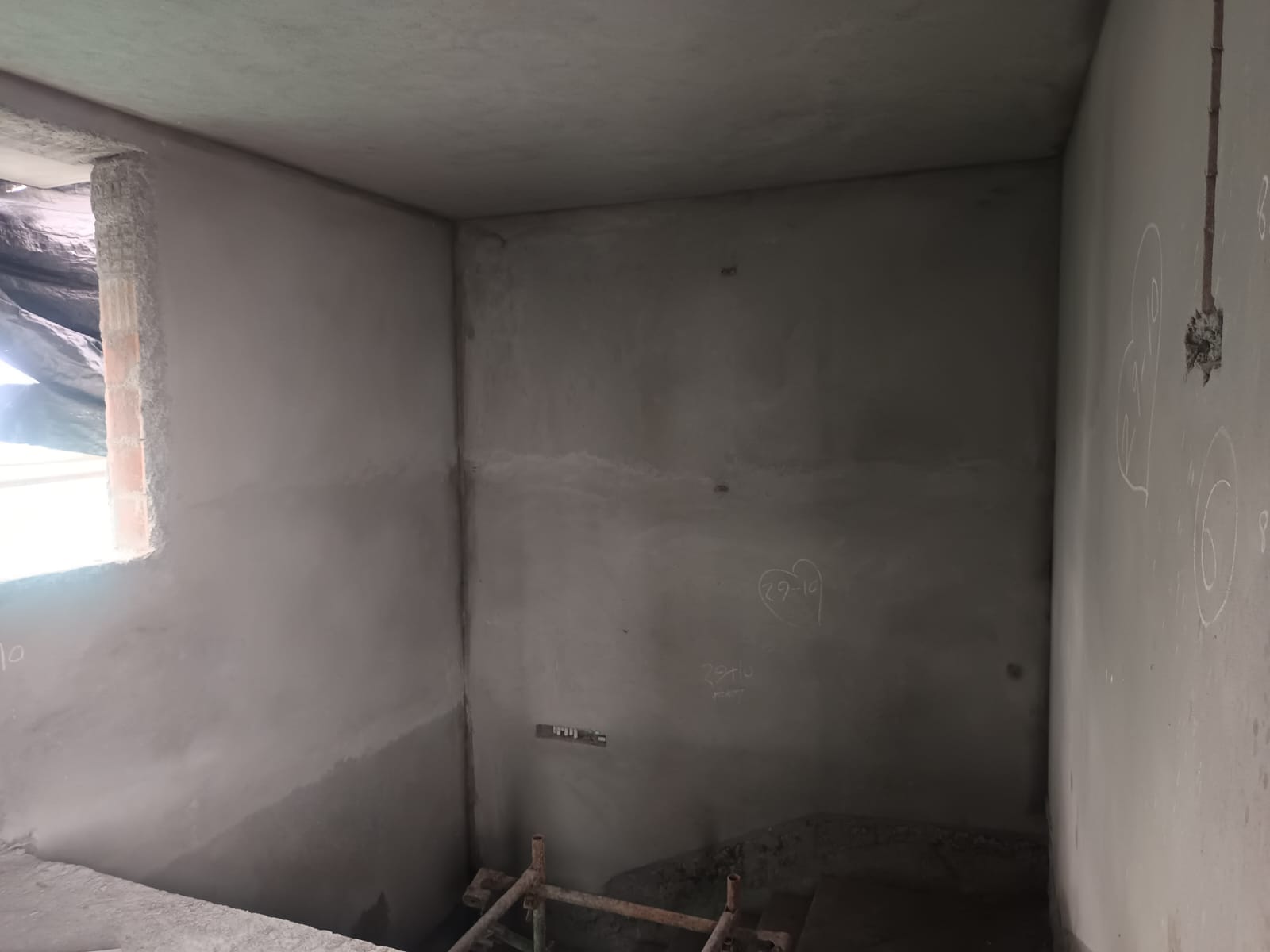

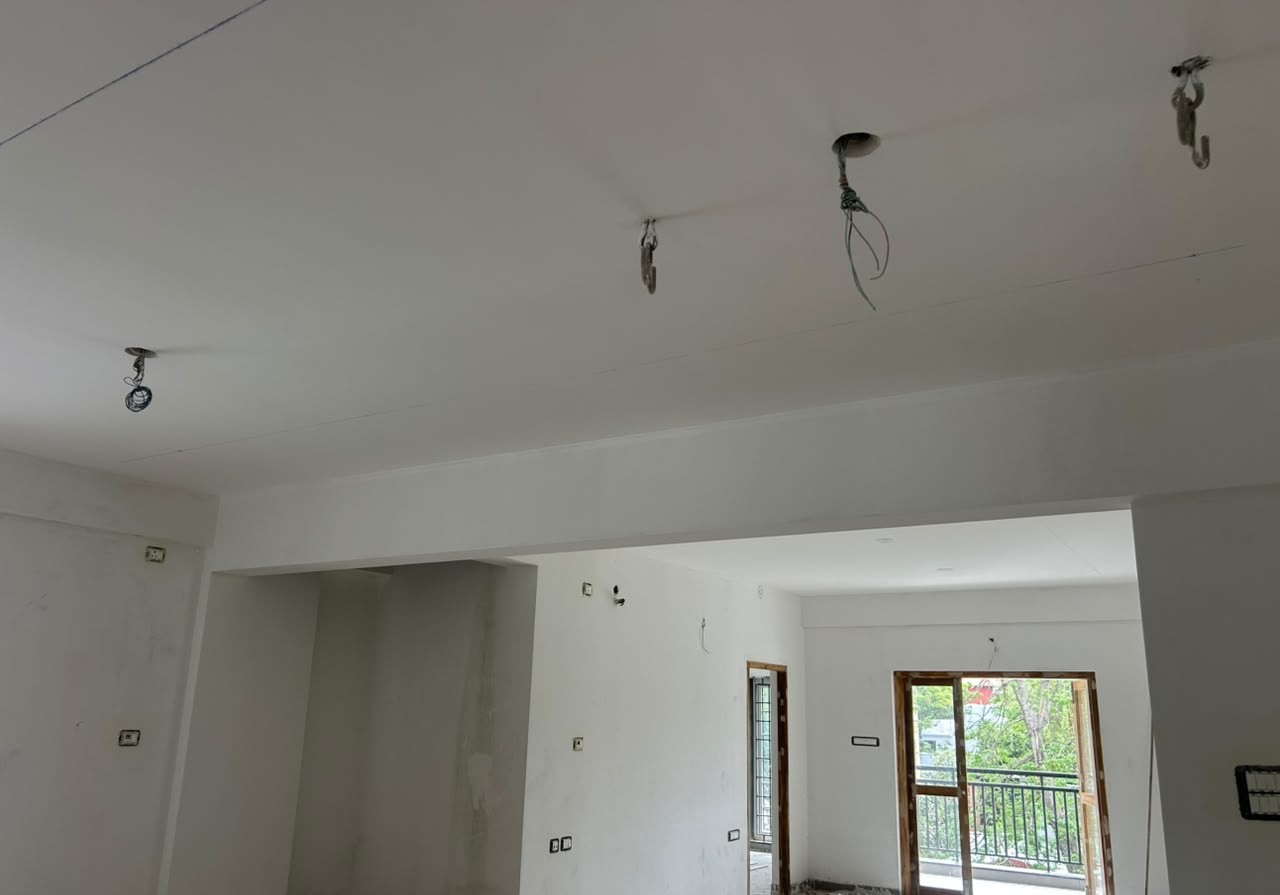

  • Inner putty work is in progress.(1st and 2nd floor progress)

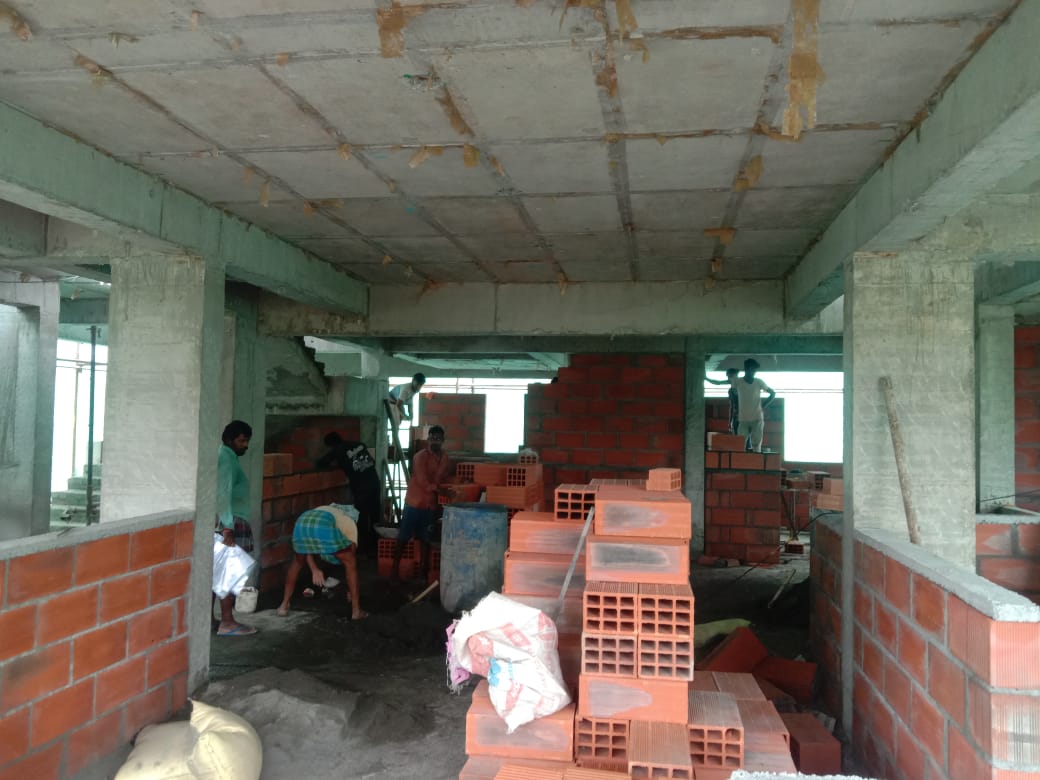

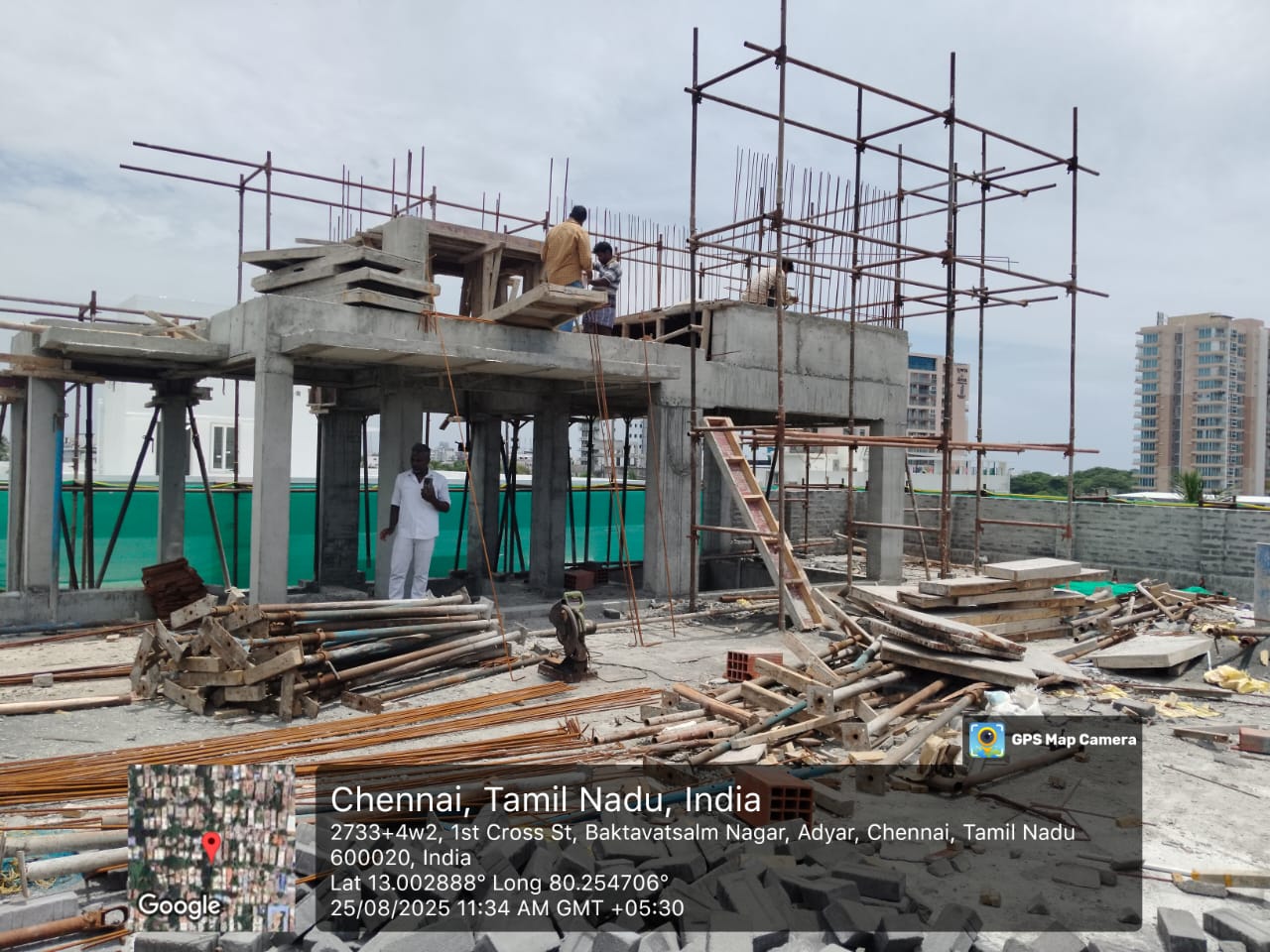

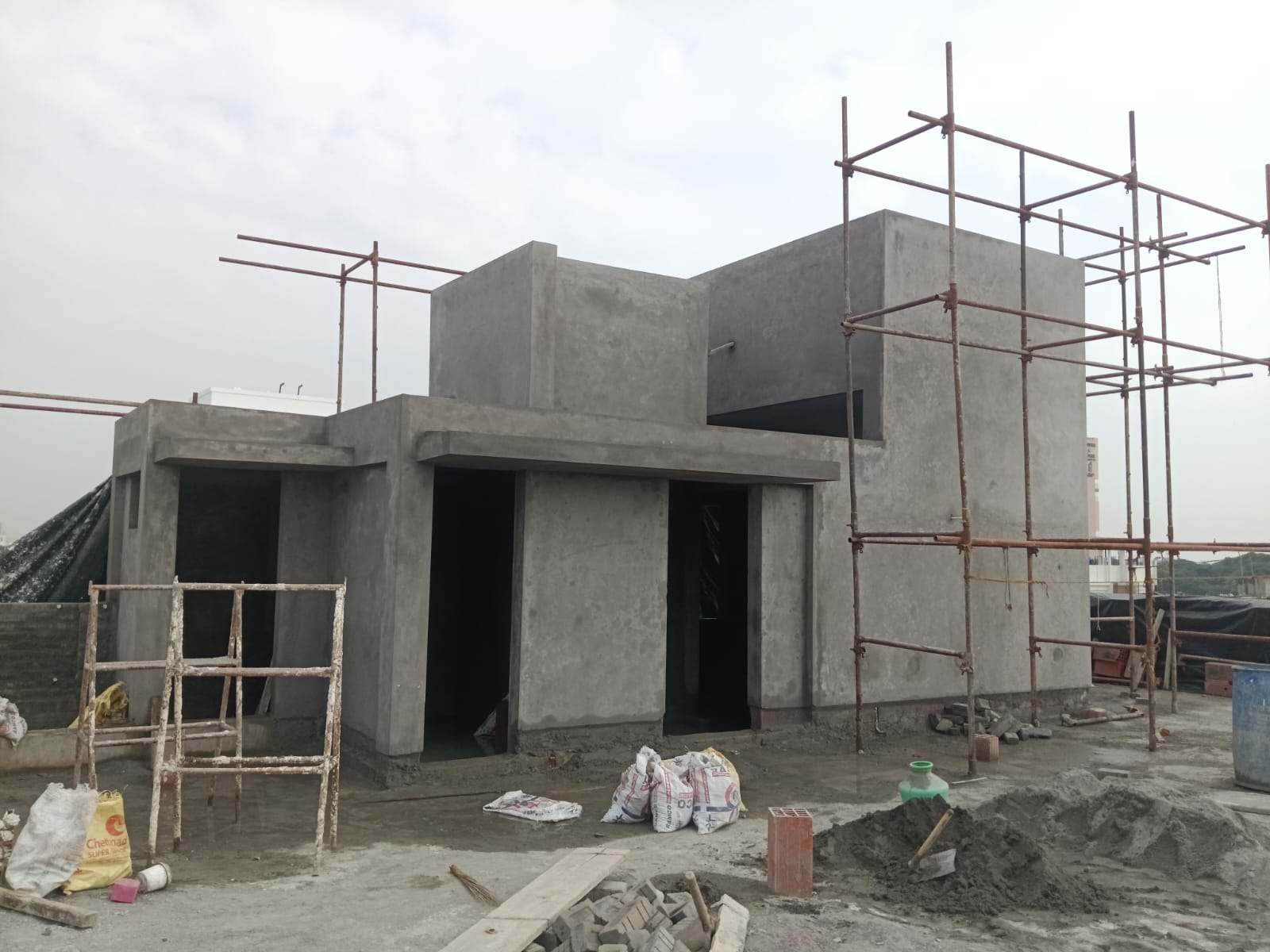

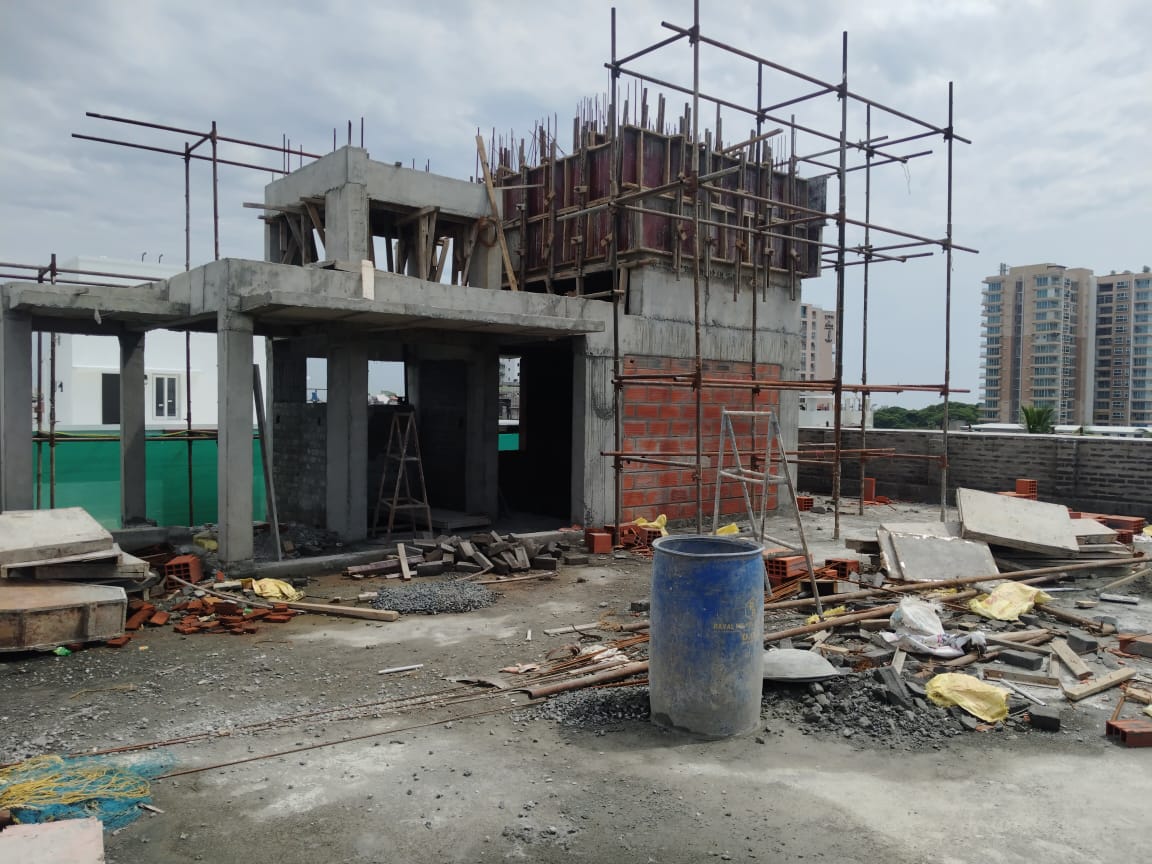

  • Stilt floor plastering work is in progress.(50% completed)

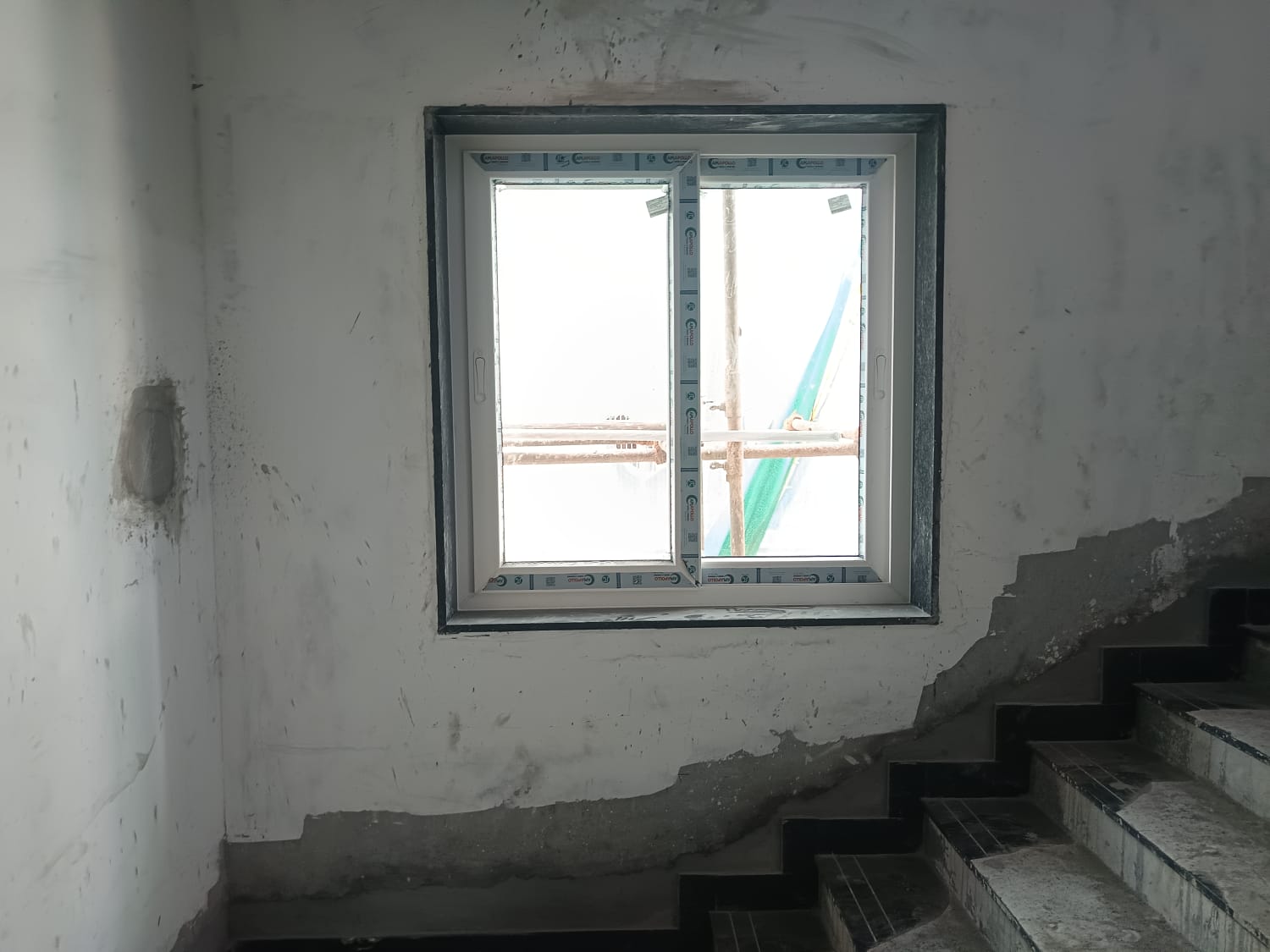

  • All floor lobby & staircase granite flooring work is in progress.(60% completed)
  • Duct plumbing work is in progress.(50% completed)
  • 5th floor toilet plumbing work is in progress.(Up to 4th floor completed)
  • General flooring work is completed.(1st and 2nd floor completed)
  • Elevation wall cladding tiles work is in progress.(80% completed)

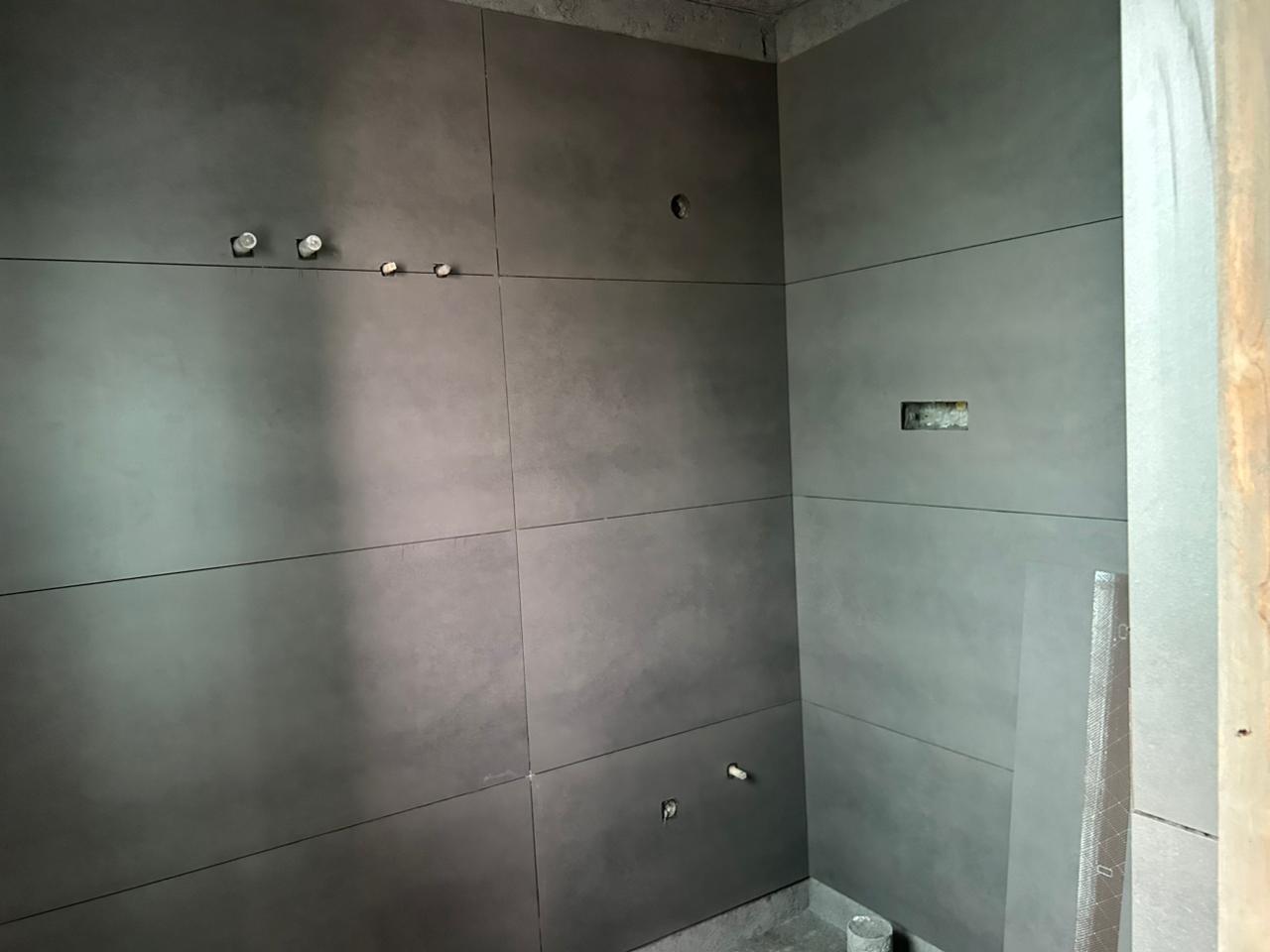

  • Toilet wall tiles work is in progress.(1stand 2nd floor completed, 3rd and 4th floor progress)

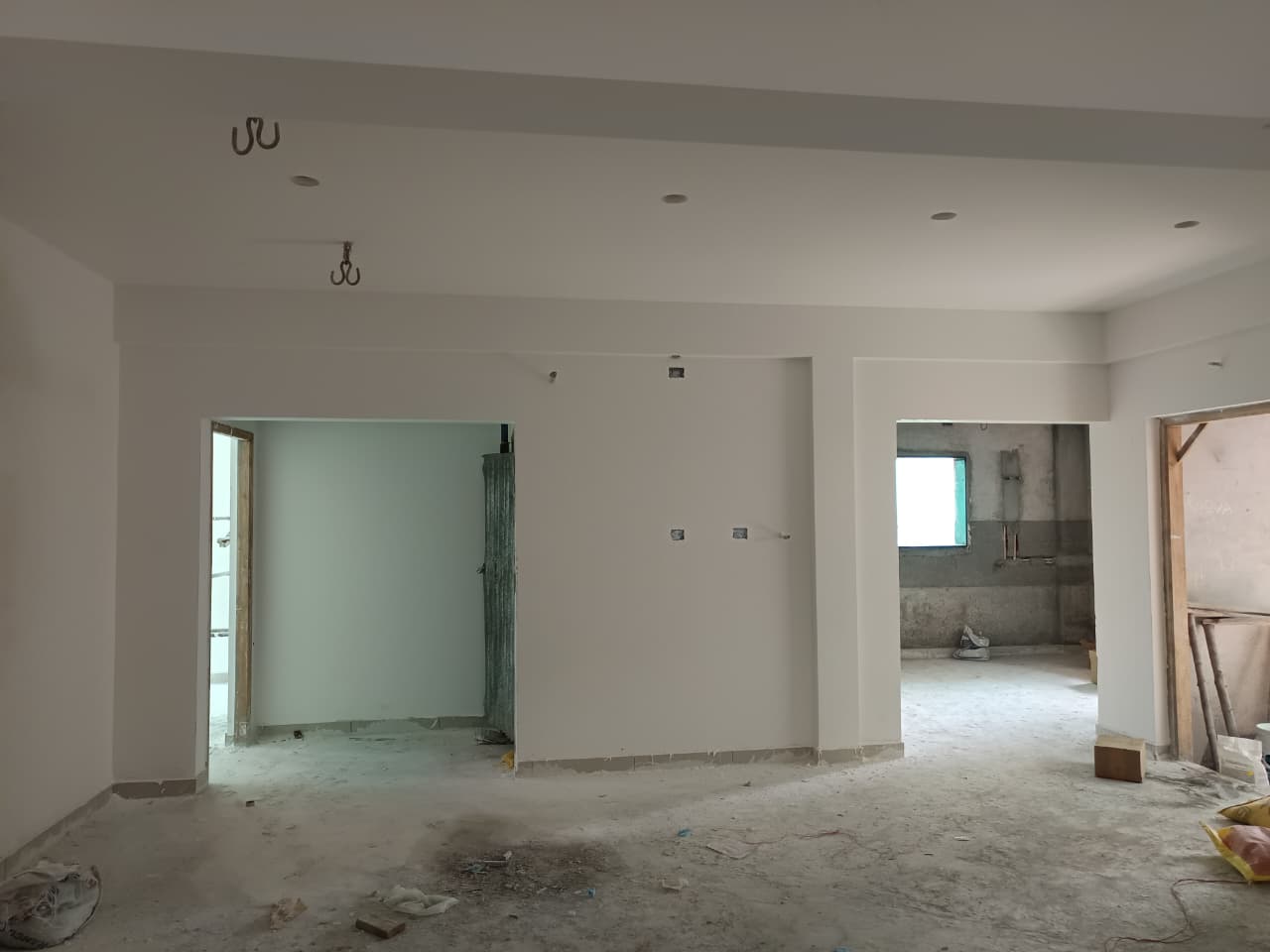

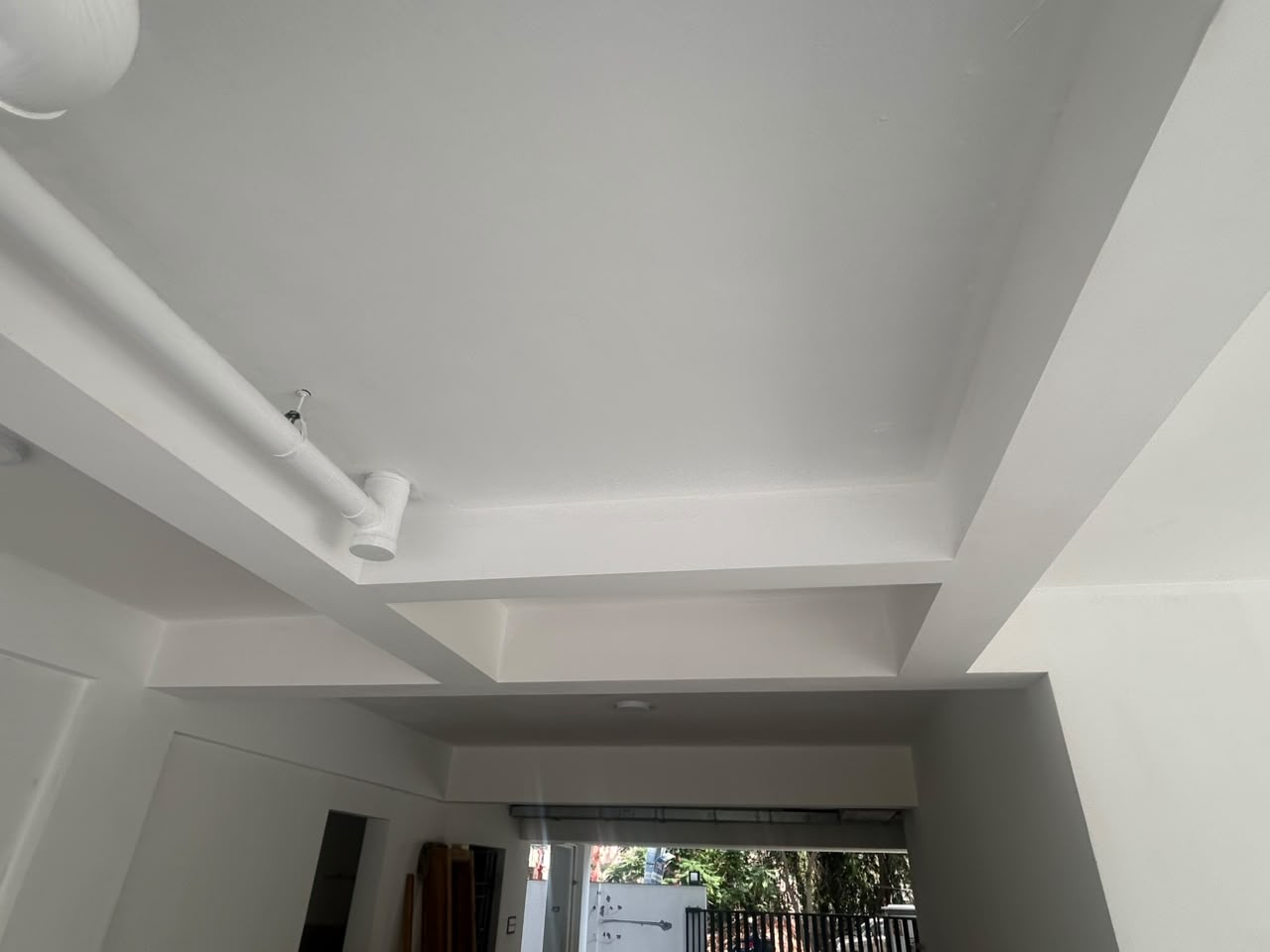

  • Texture painting work is completed.
  • Terrace weathering course work is completed.
  • Inner putty work is in progress.(1st and 2nd floor completed,3rd floor progress)
  • Stilt floor plastering work is in progress.(70% completed)
  • All floor lobby & staircase granite flooring work is in progress.(40% completed)
  • Duct plumbing work is in progress.(60% completed)
