Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Ashok Vihar

Ashok Nagar

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup

Elevators
24/7 Power Backup
Rain Water Harvesting

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
5B 5 2BHK + 2T 1026 South Available

Approvals

Planning Permit No:

OL-PP/NHRB/C/0032/2025,

Date of Permit:

2025-02-03

Building Permission No:

CEBA / WDCN10 / 00063 / 2025

Date of Permit:

2025-02-12

TNRERA:

TN/29/Building/0159/2025

Dated:

2025-04-30

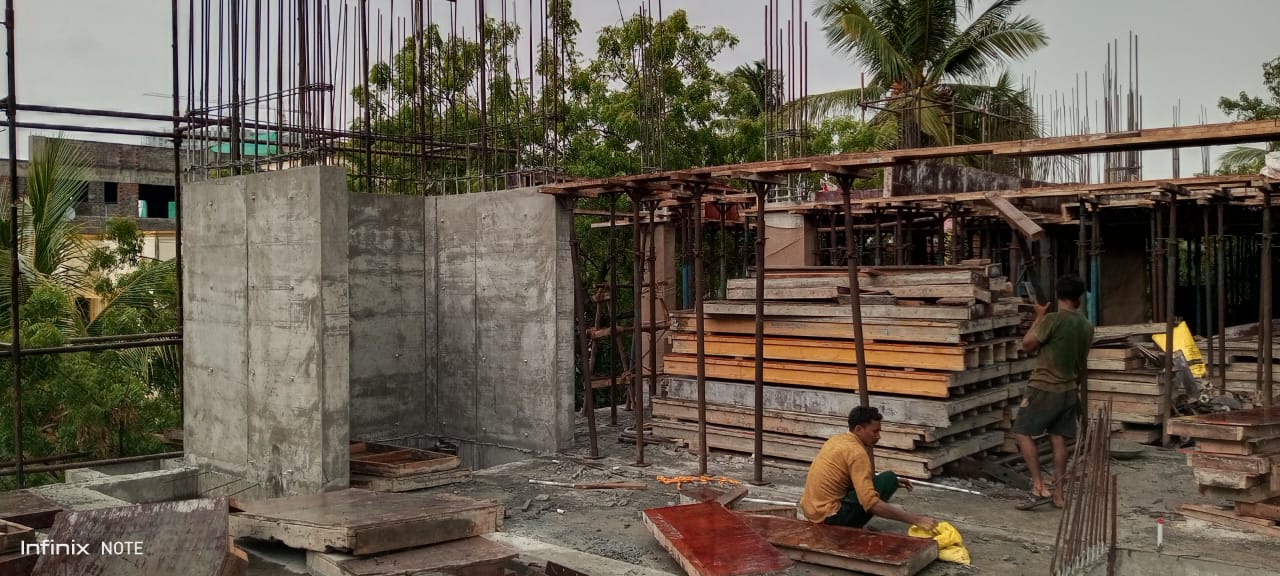

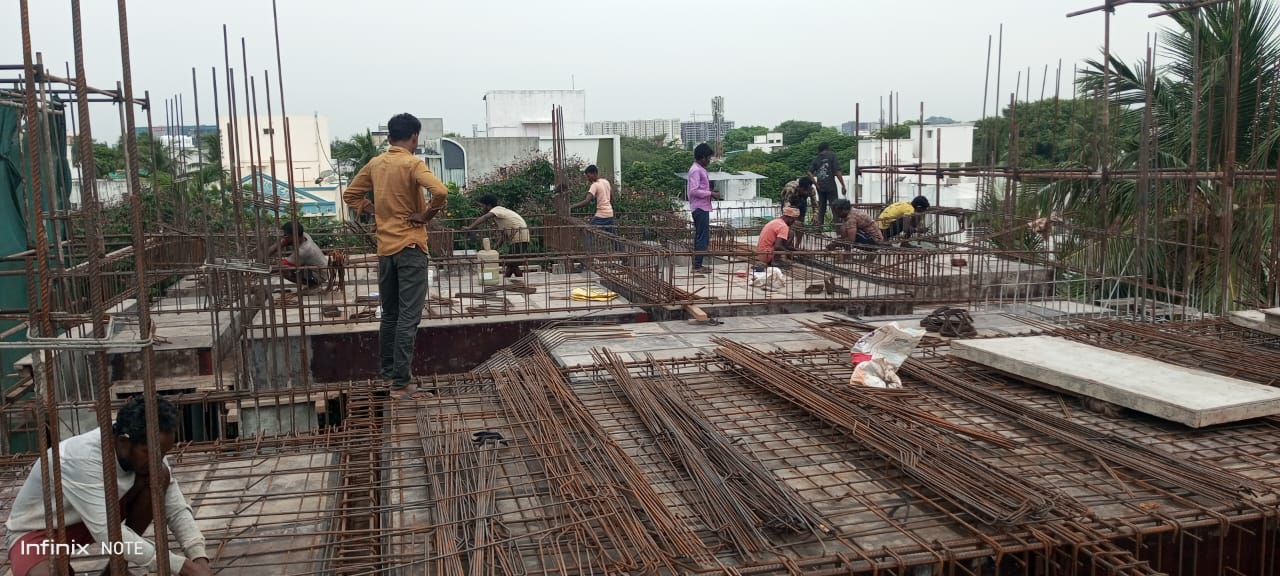

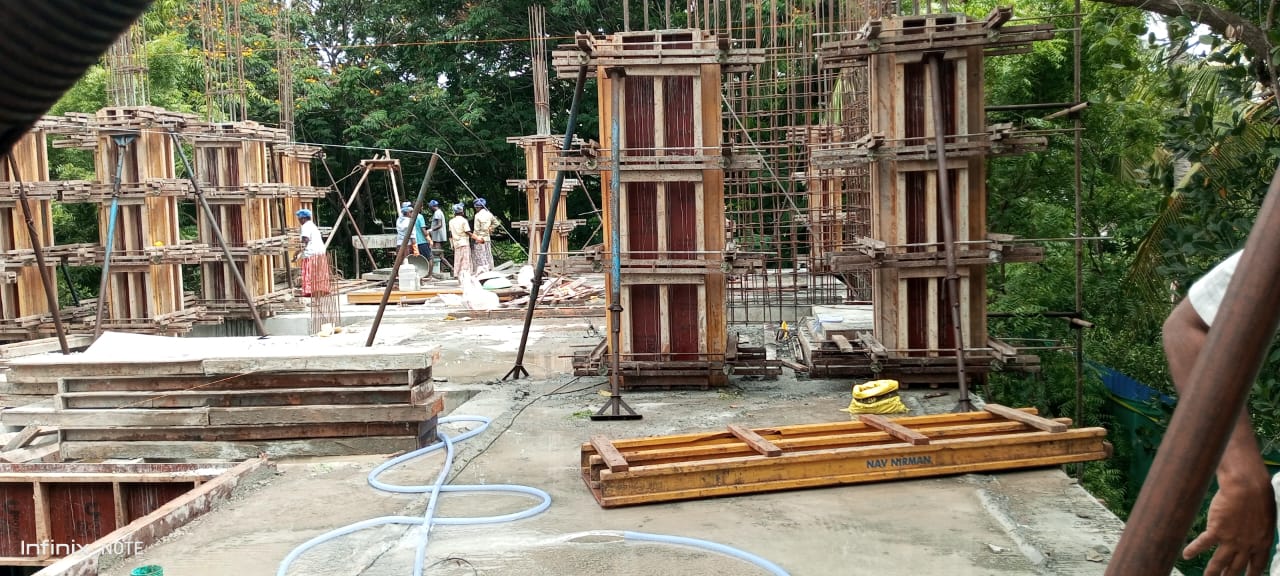

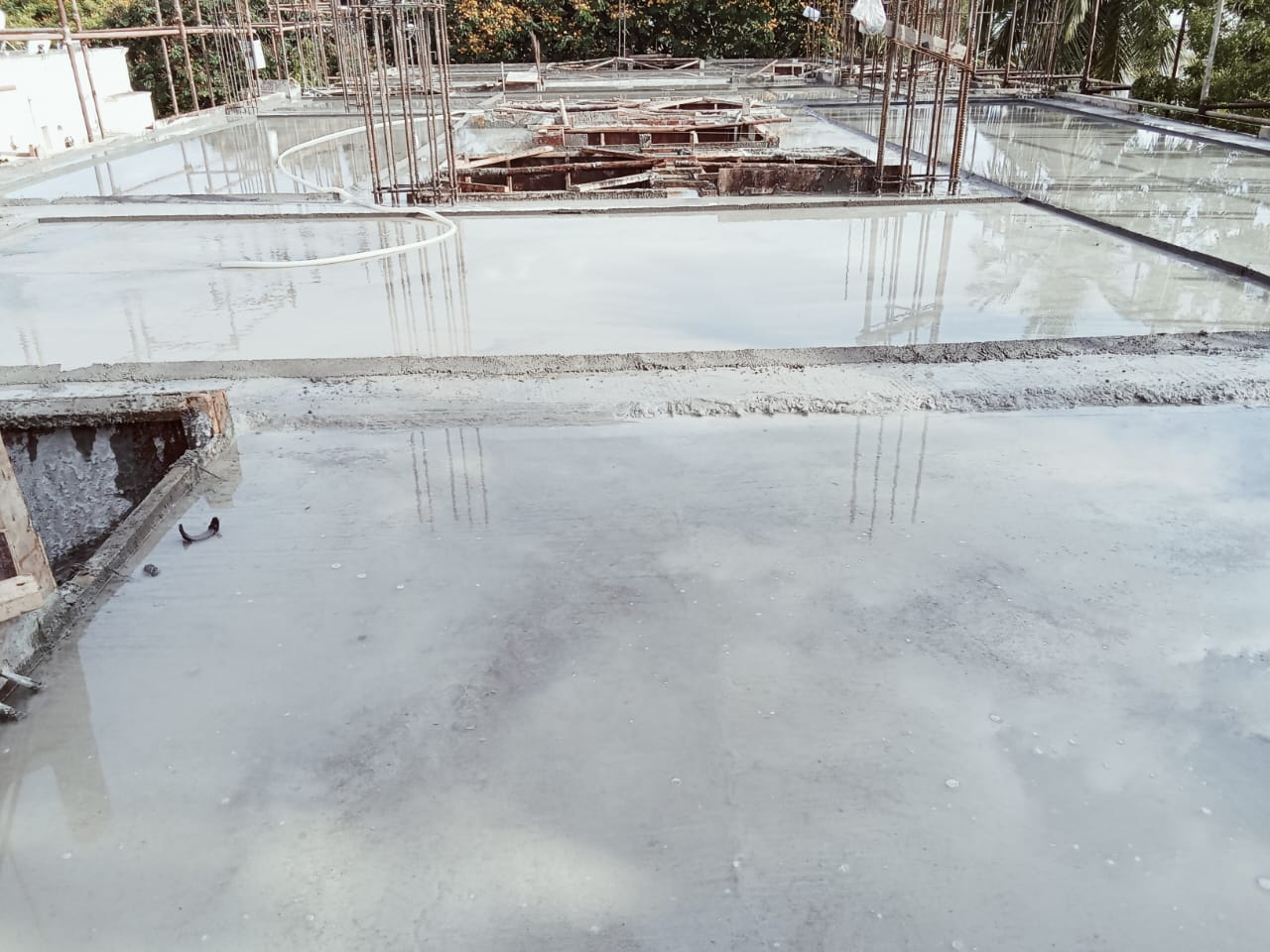

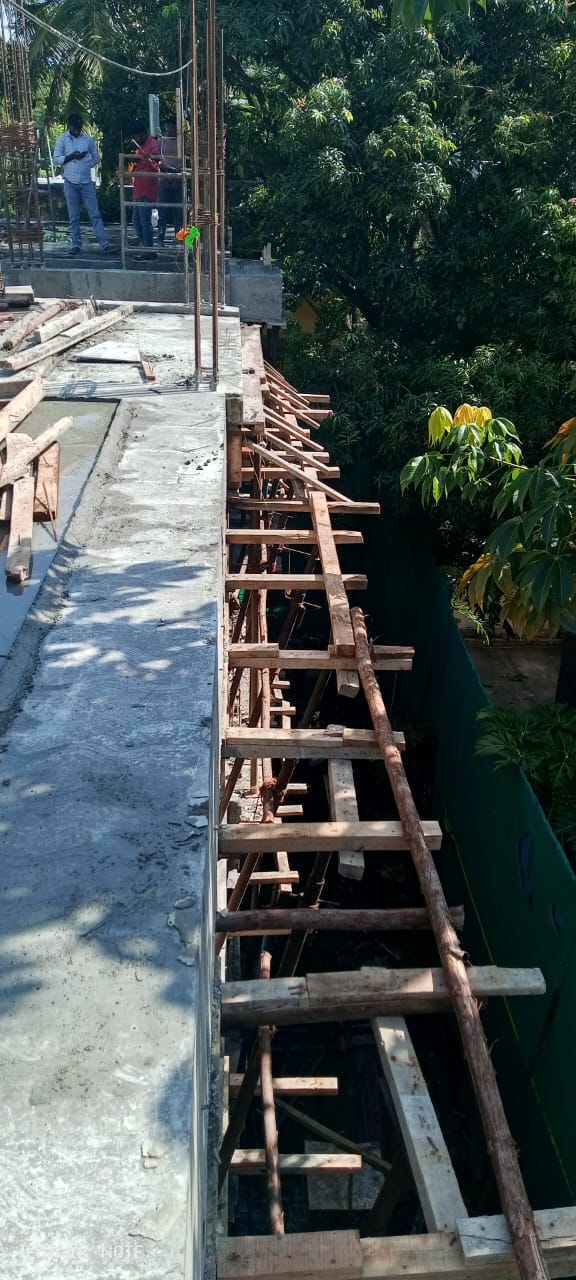

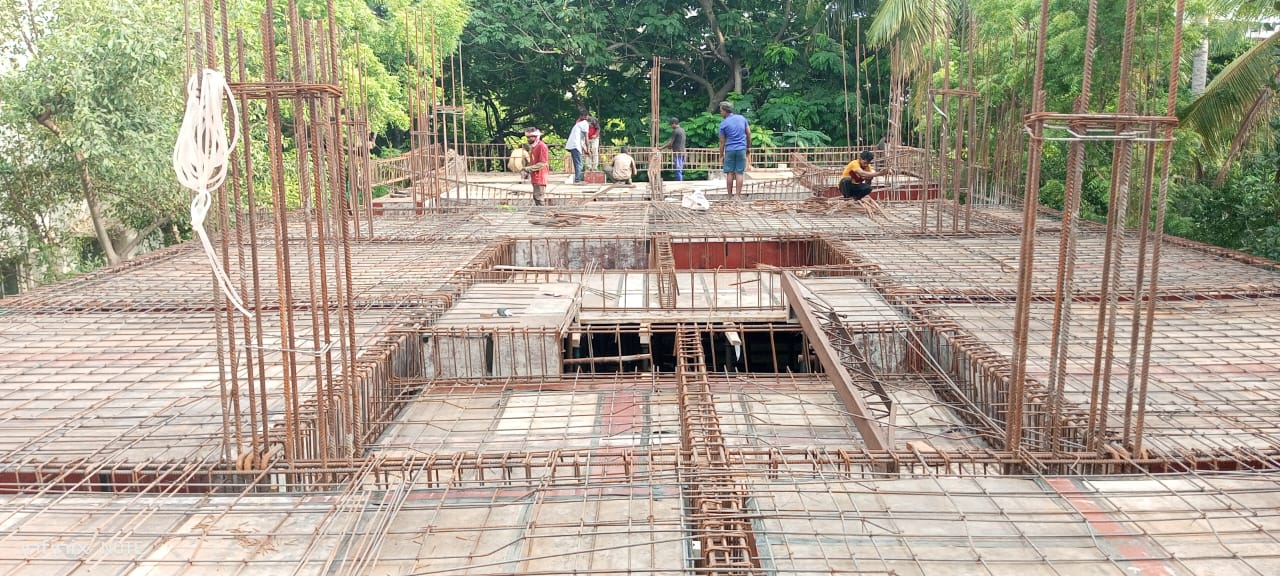

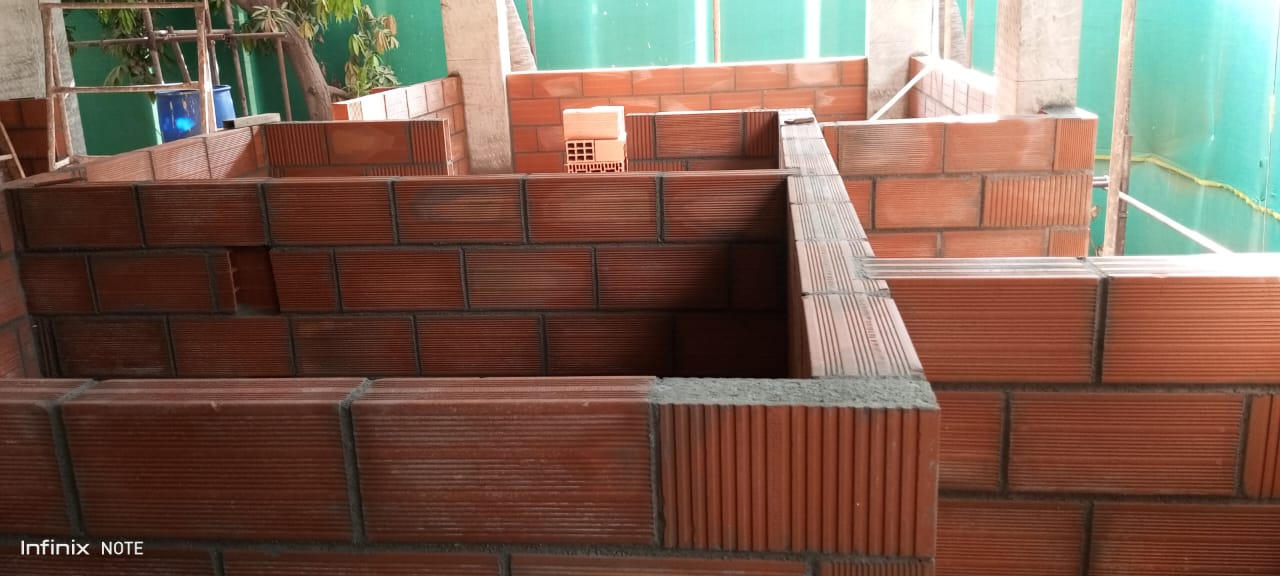

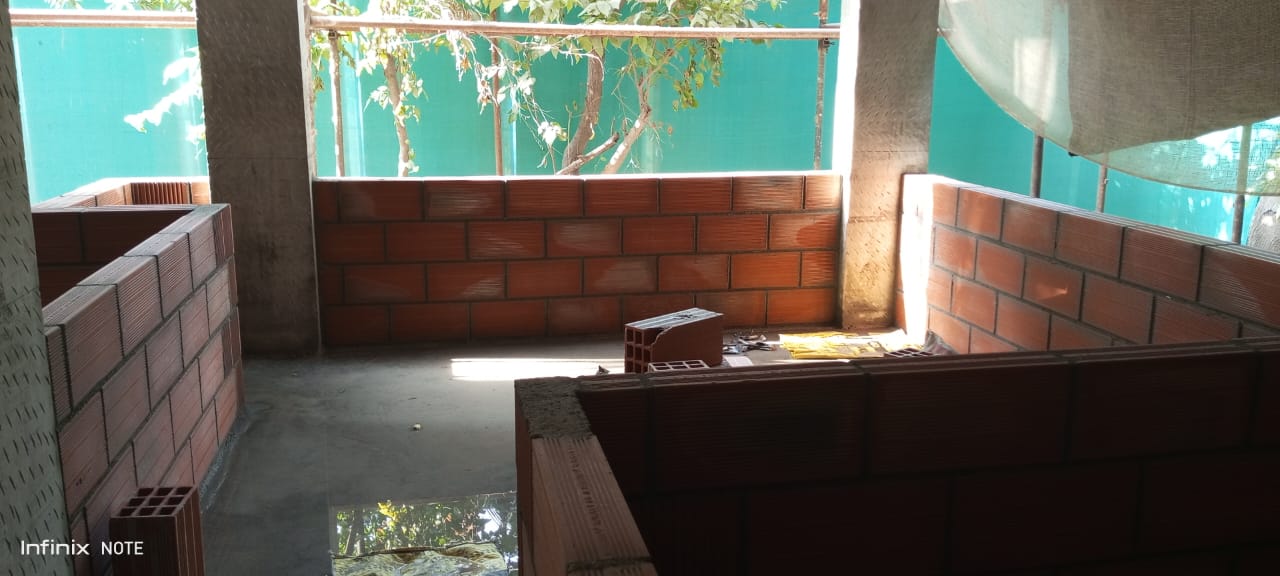

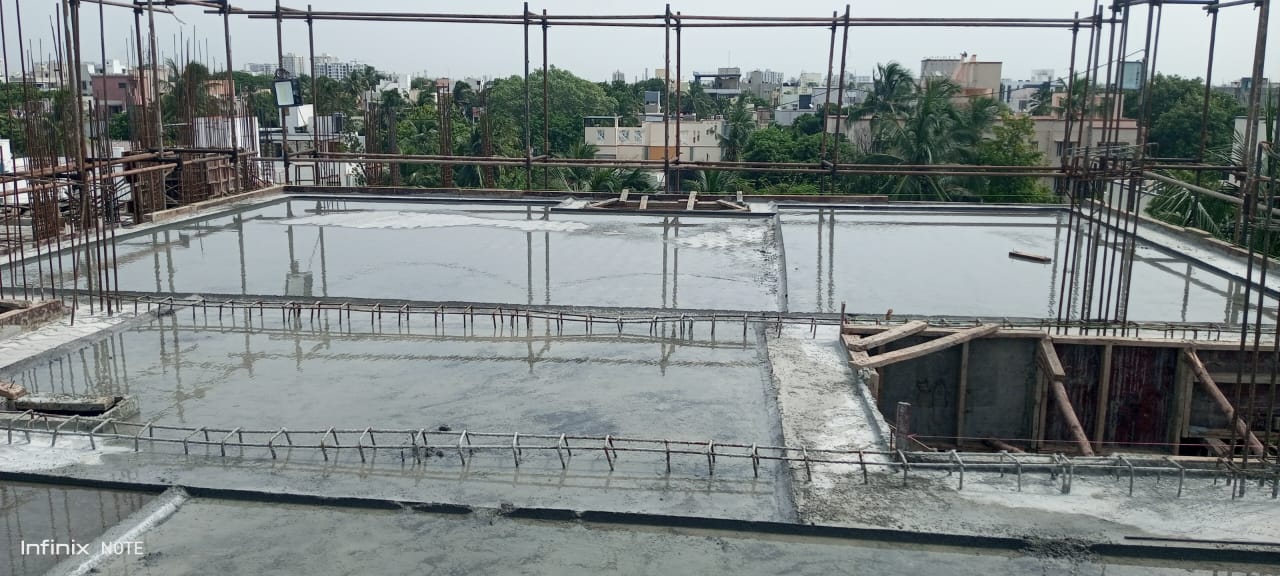

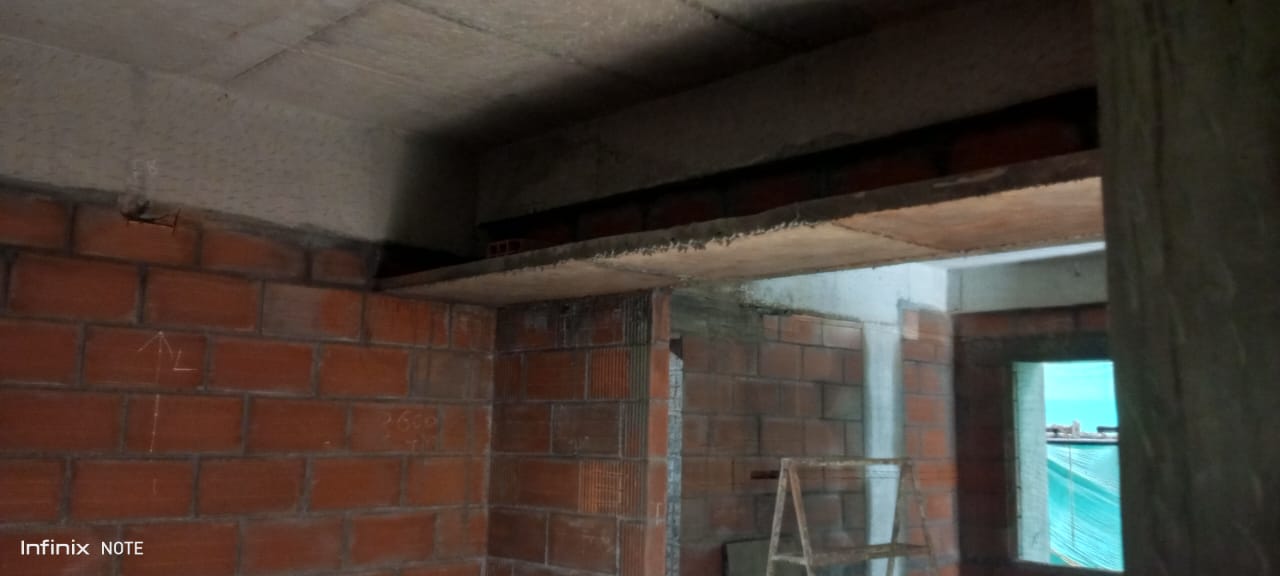

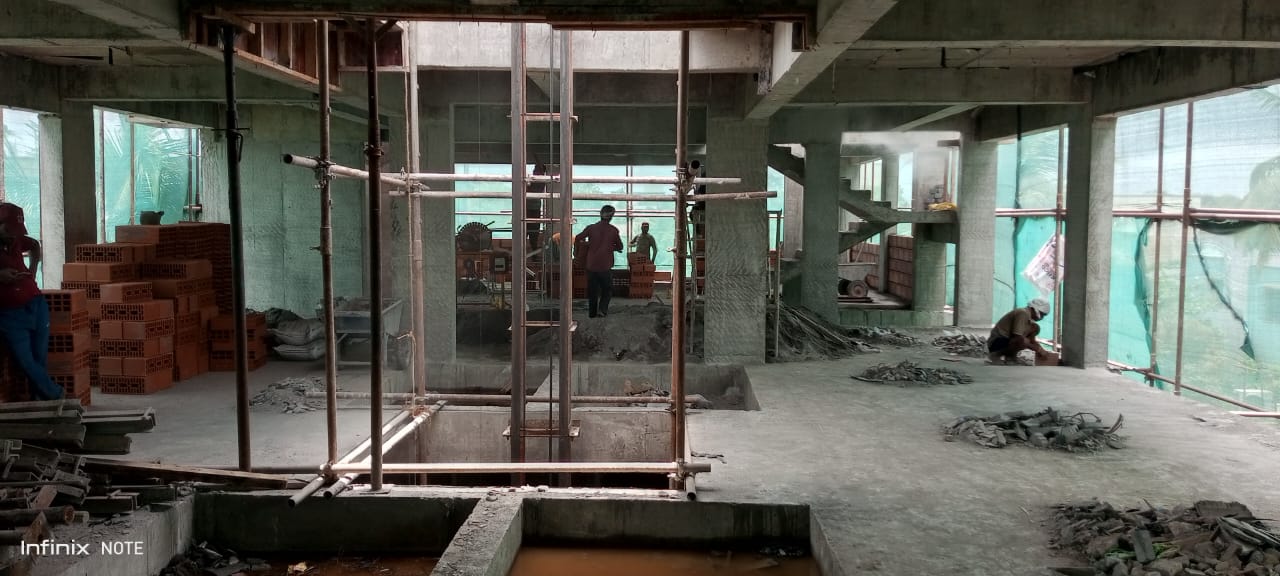

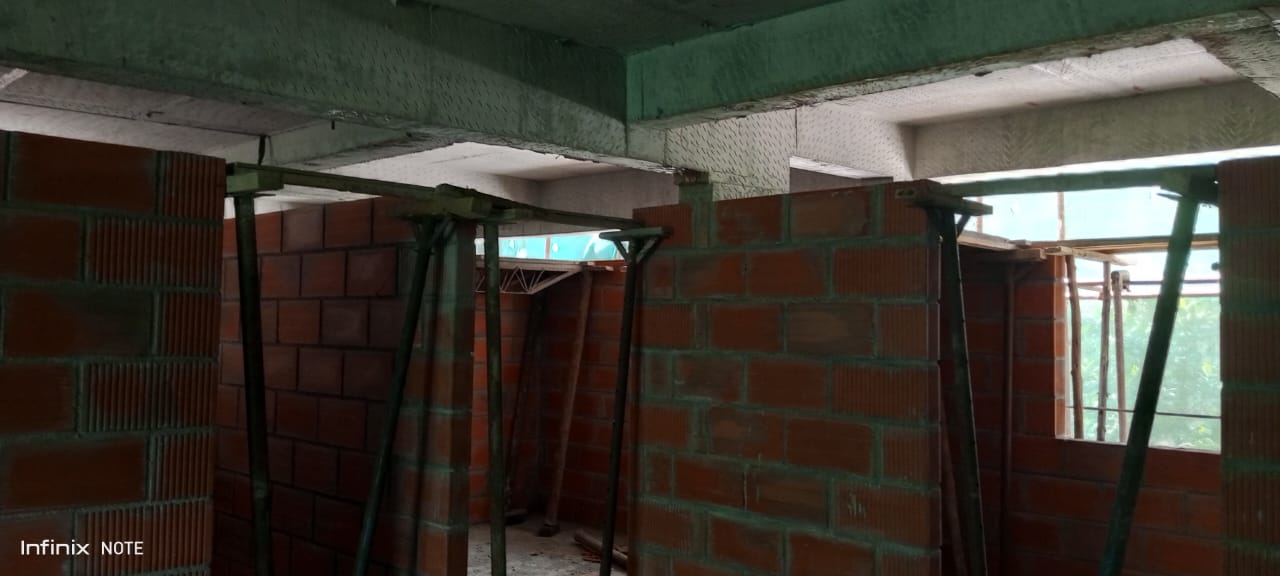

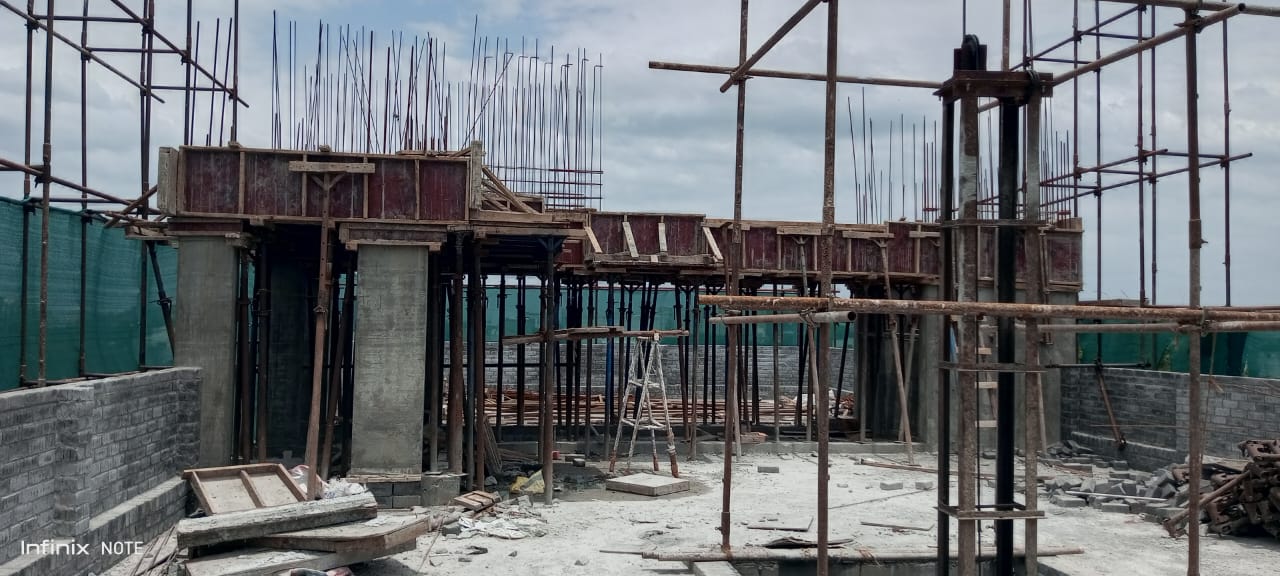

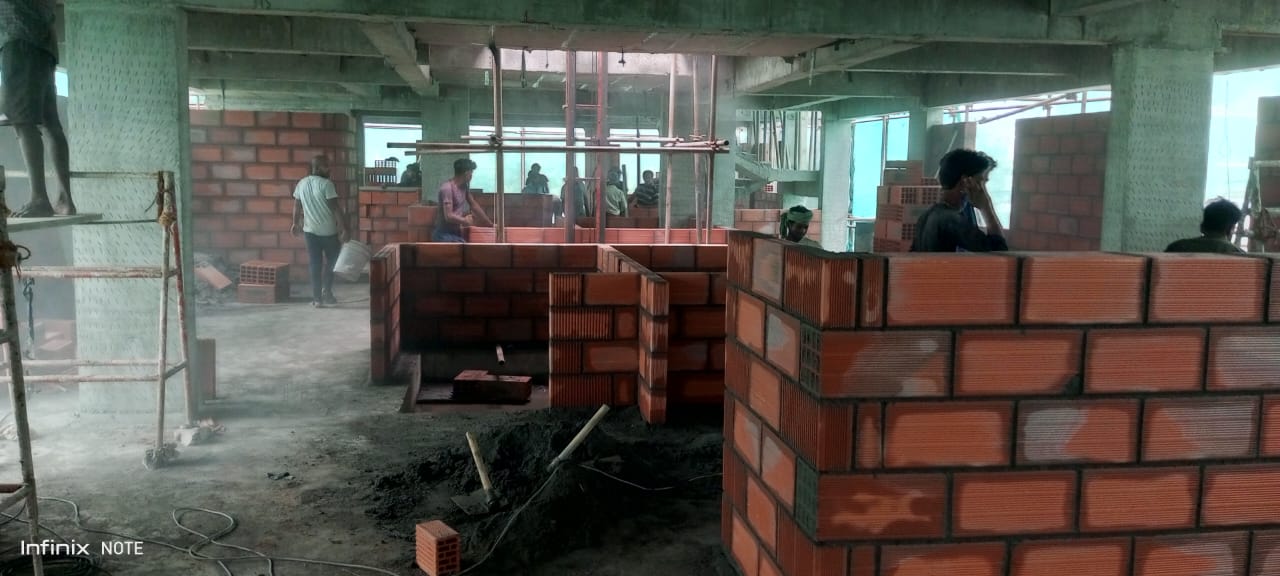

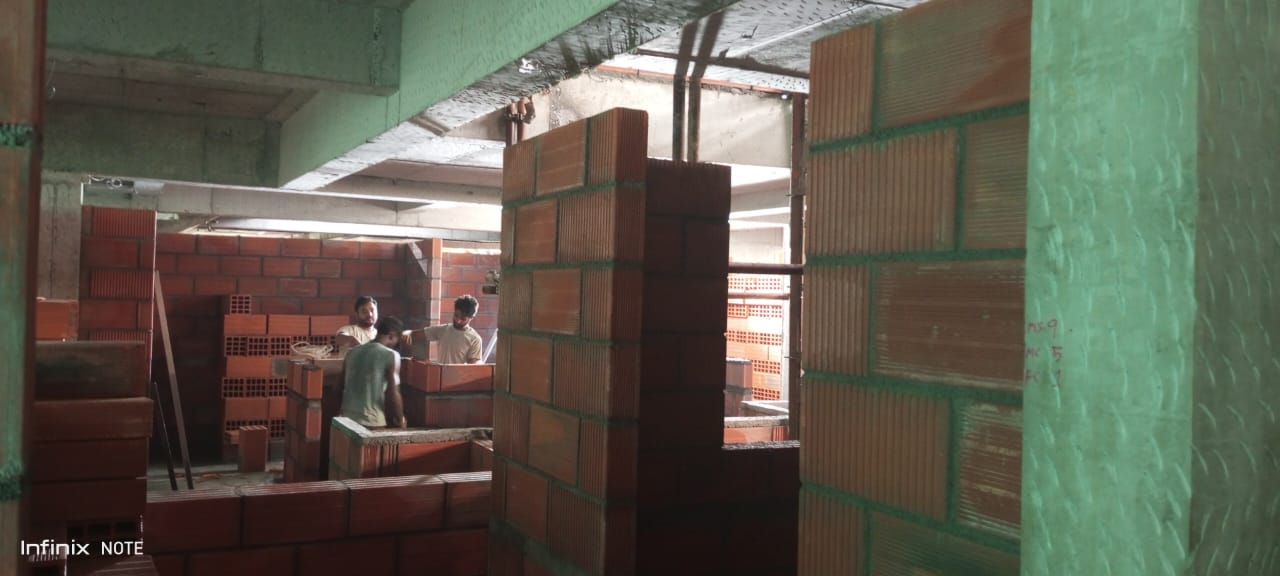

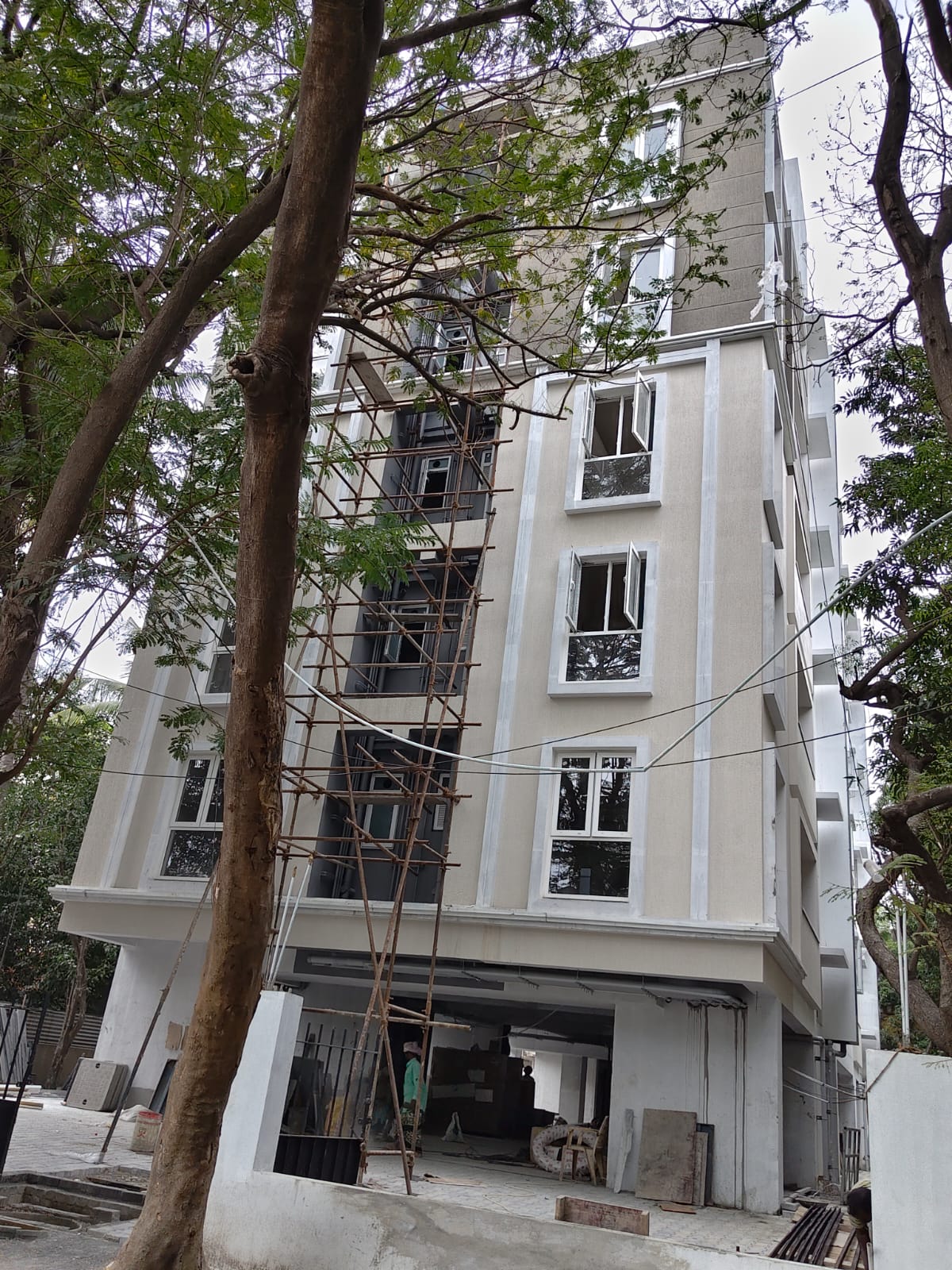

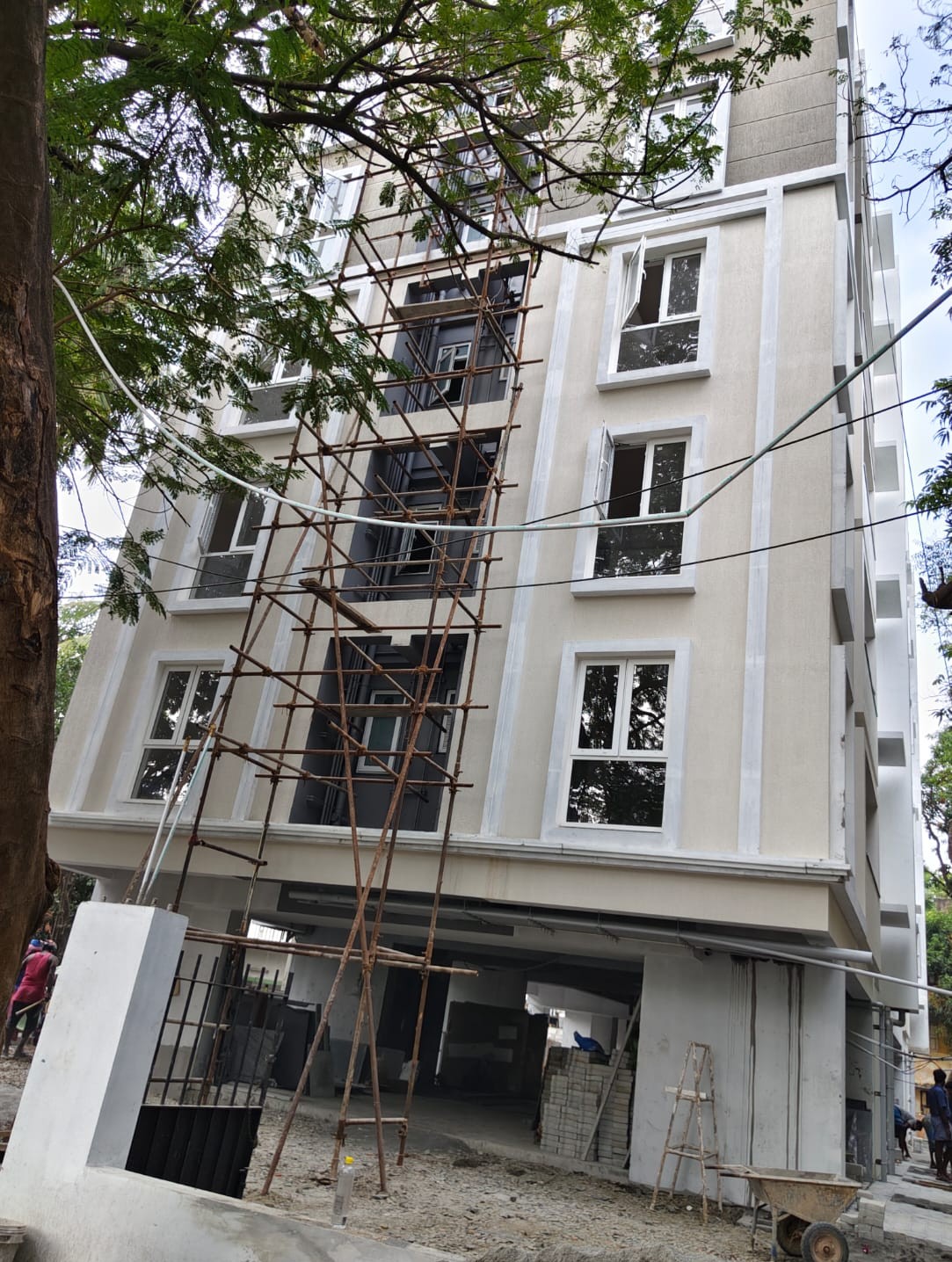

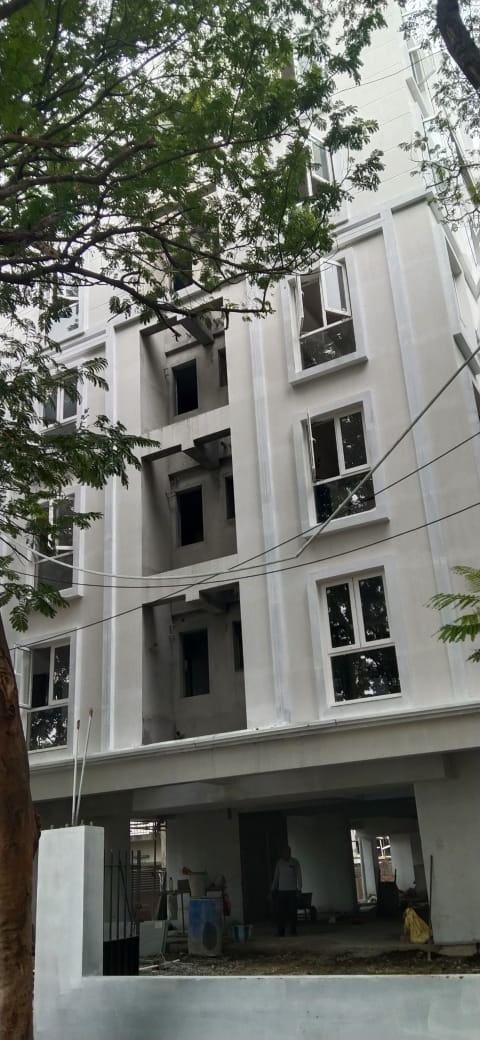

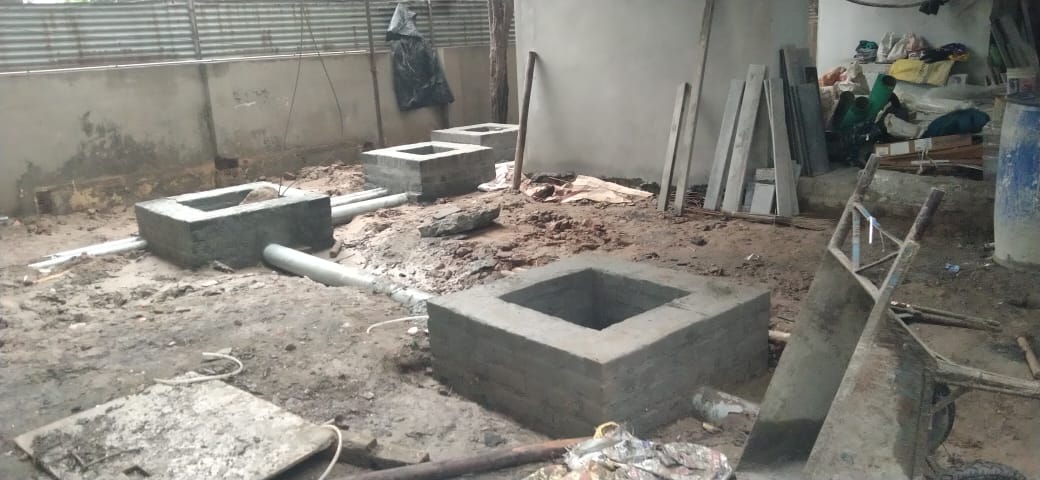

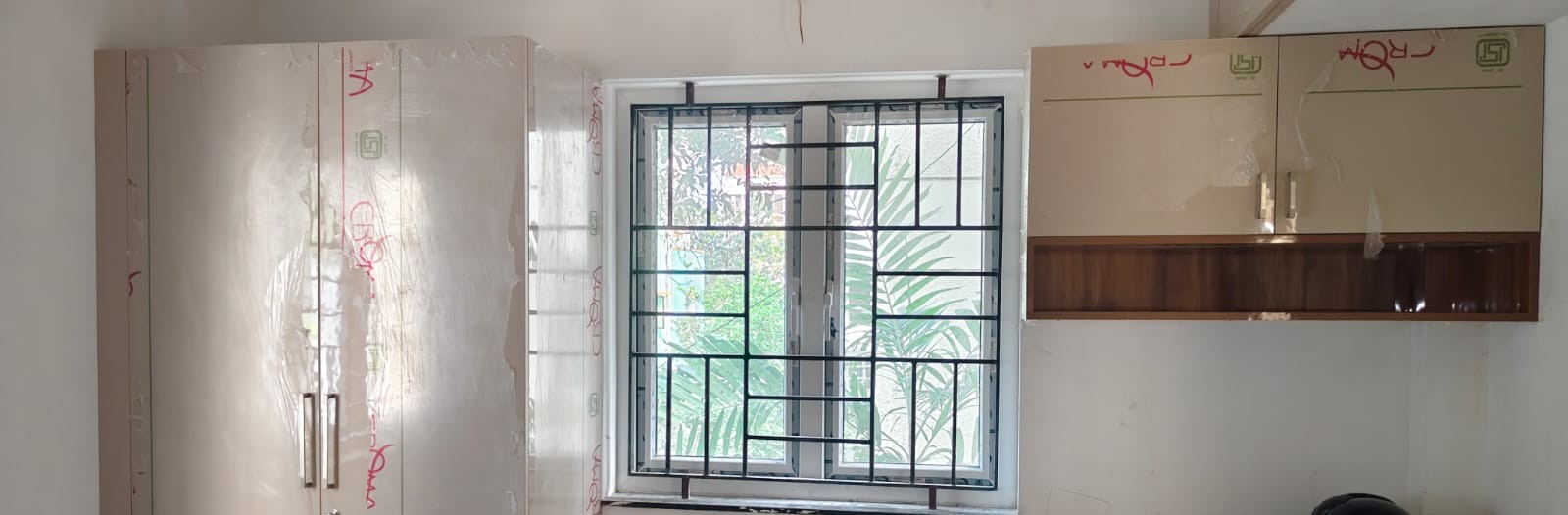

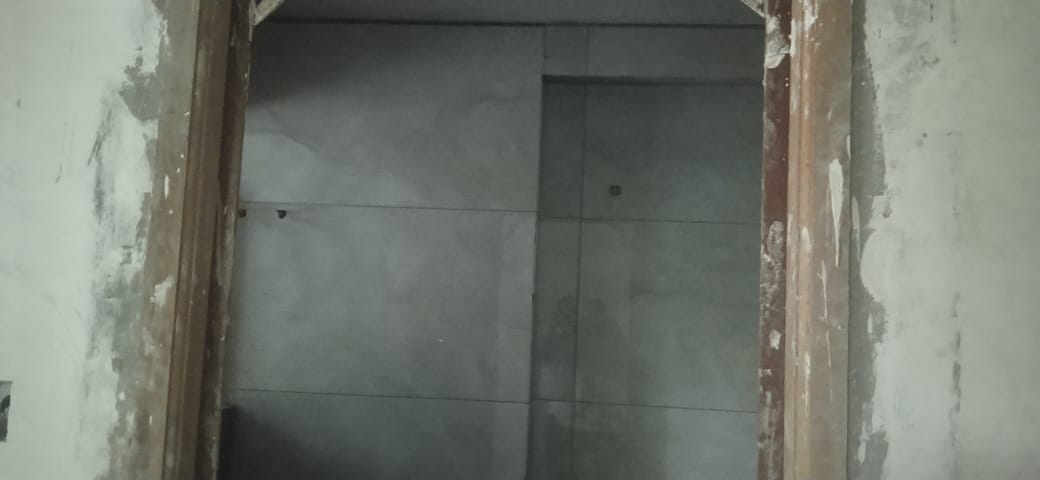

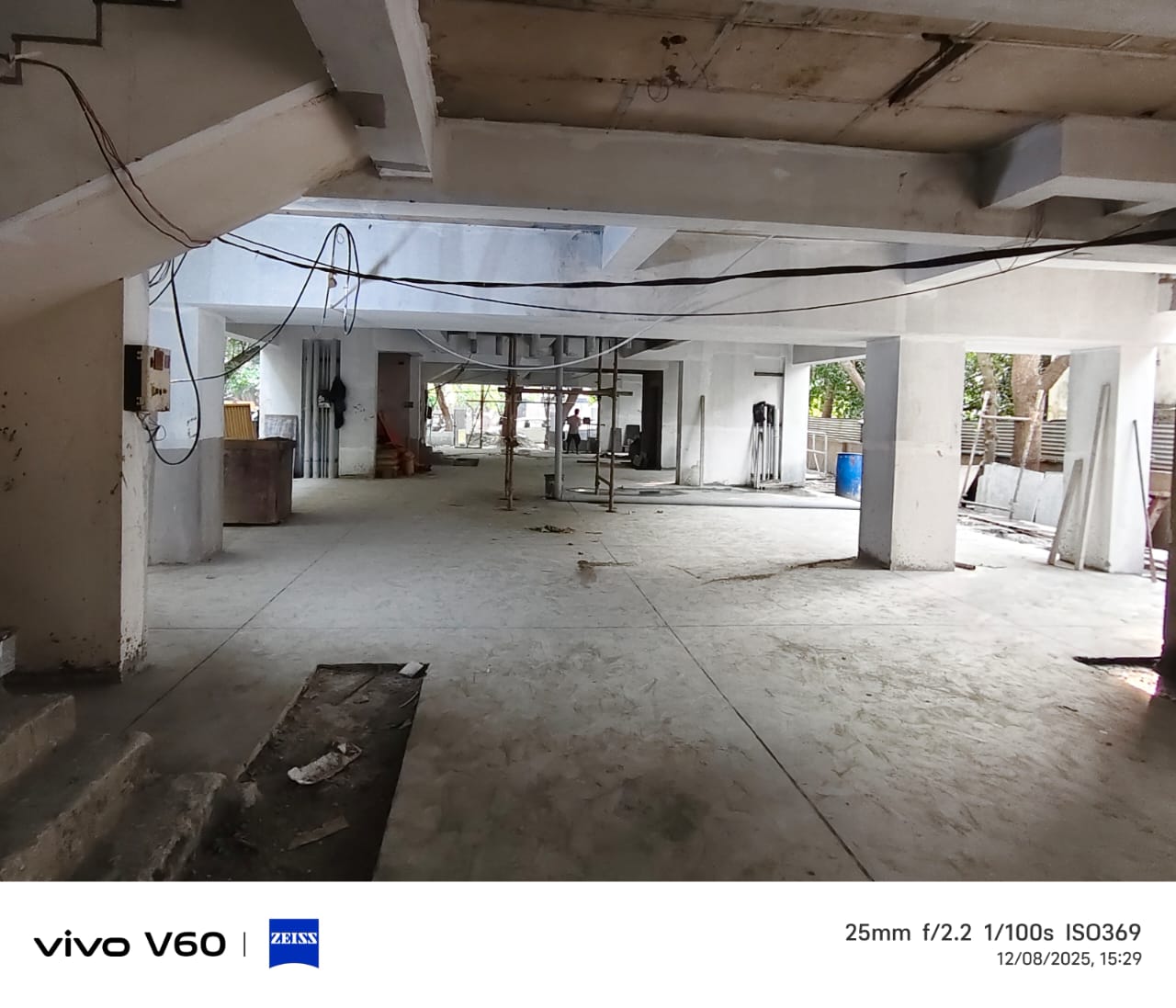

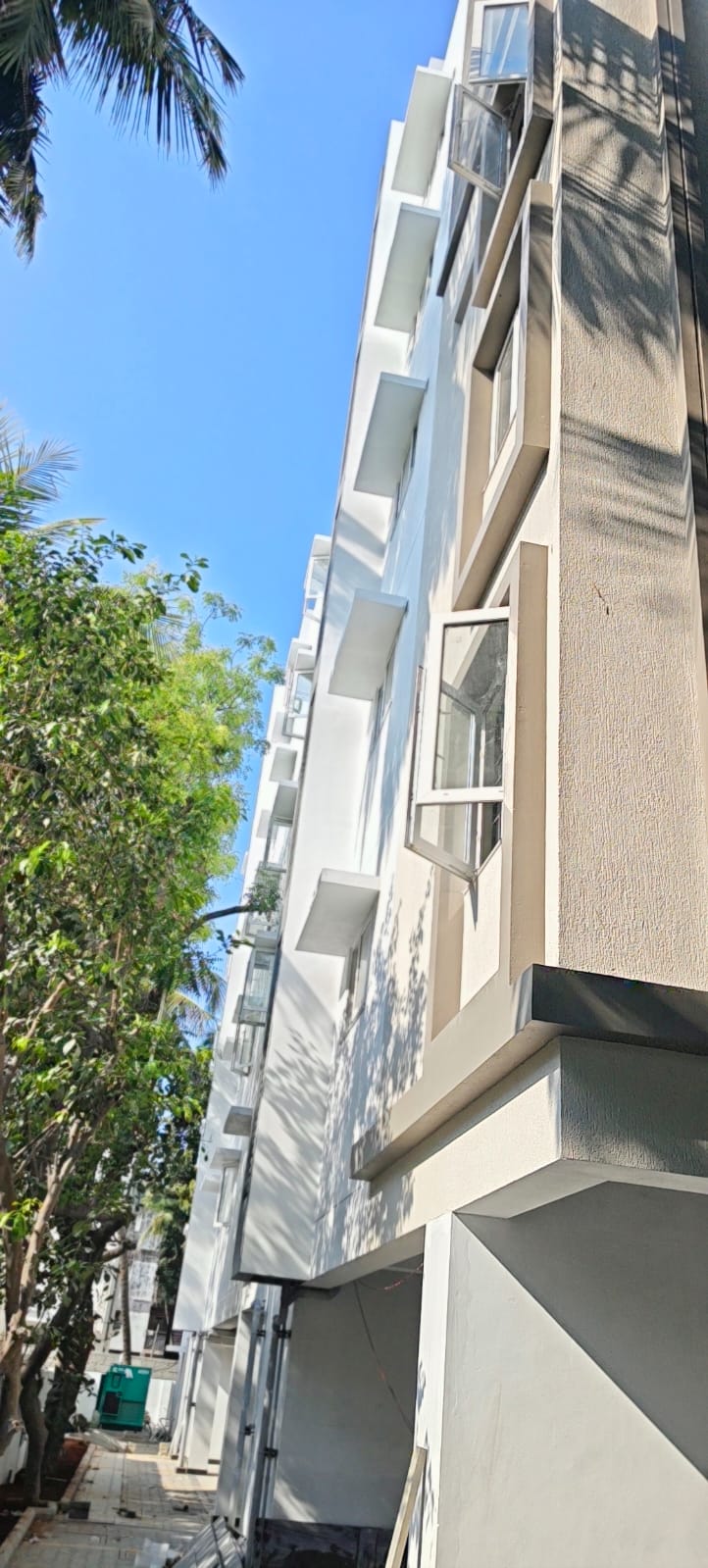

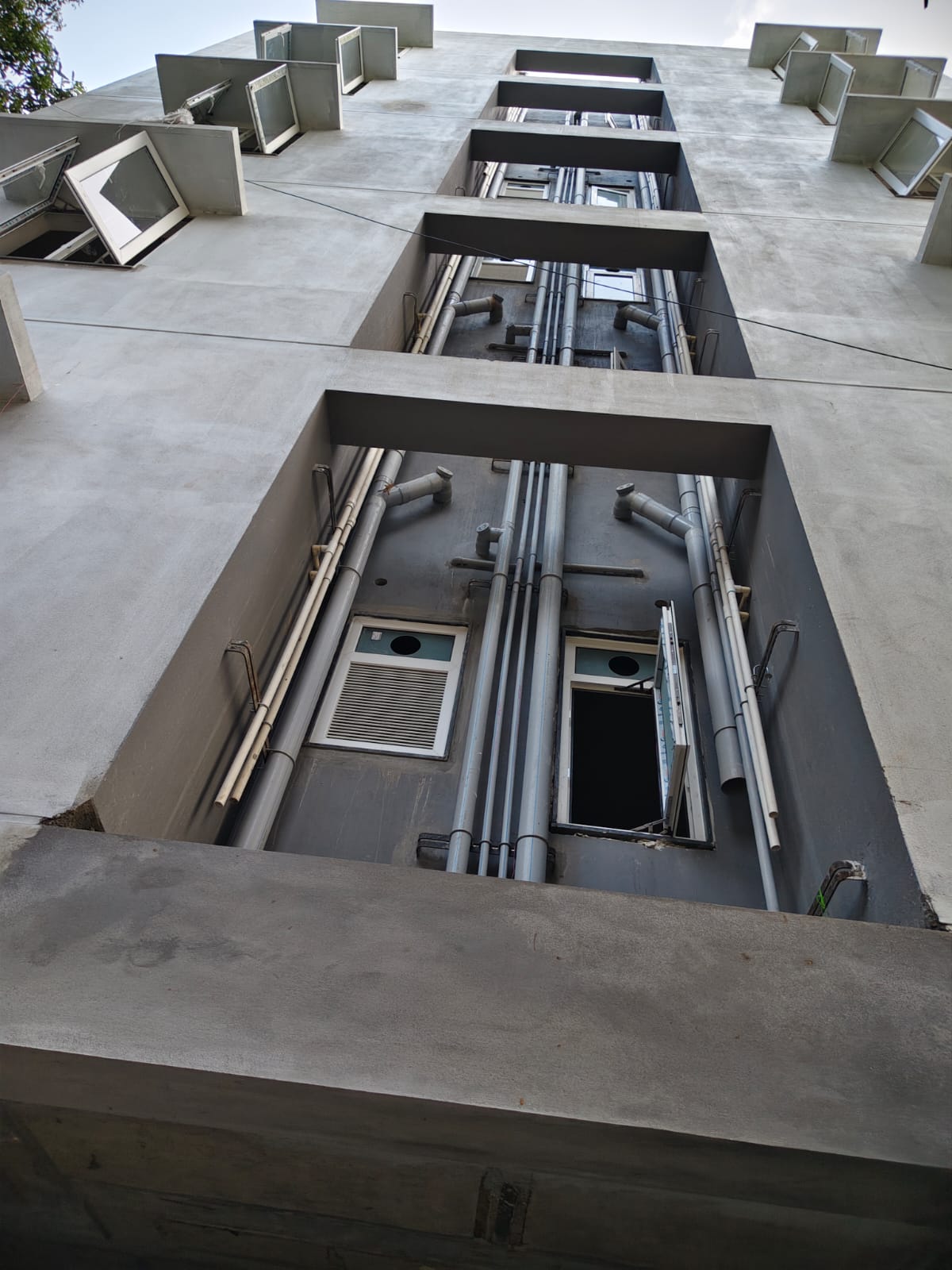

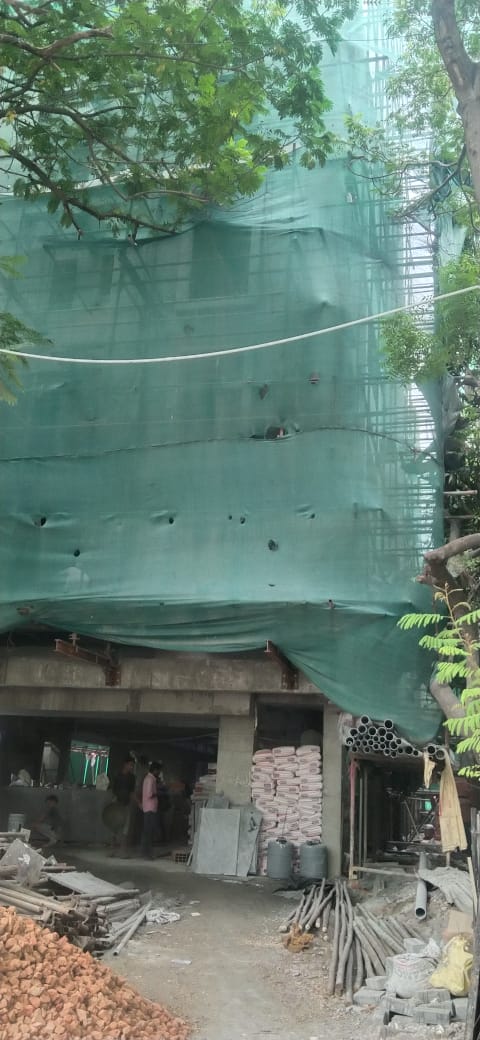

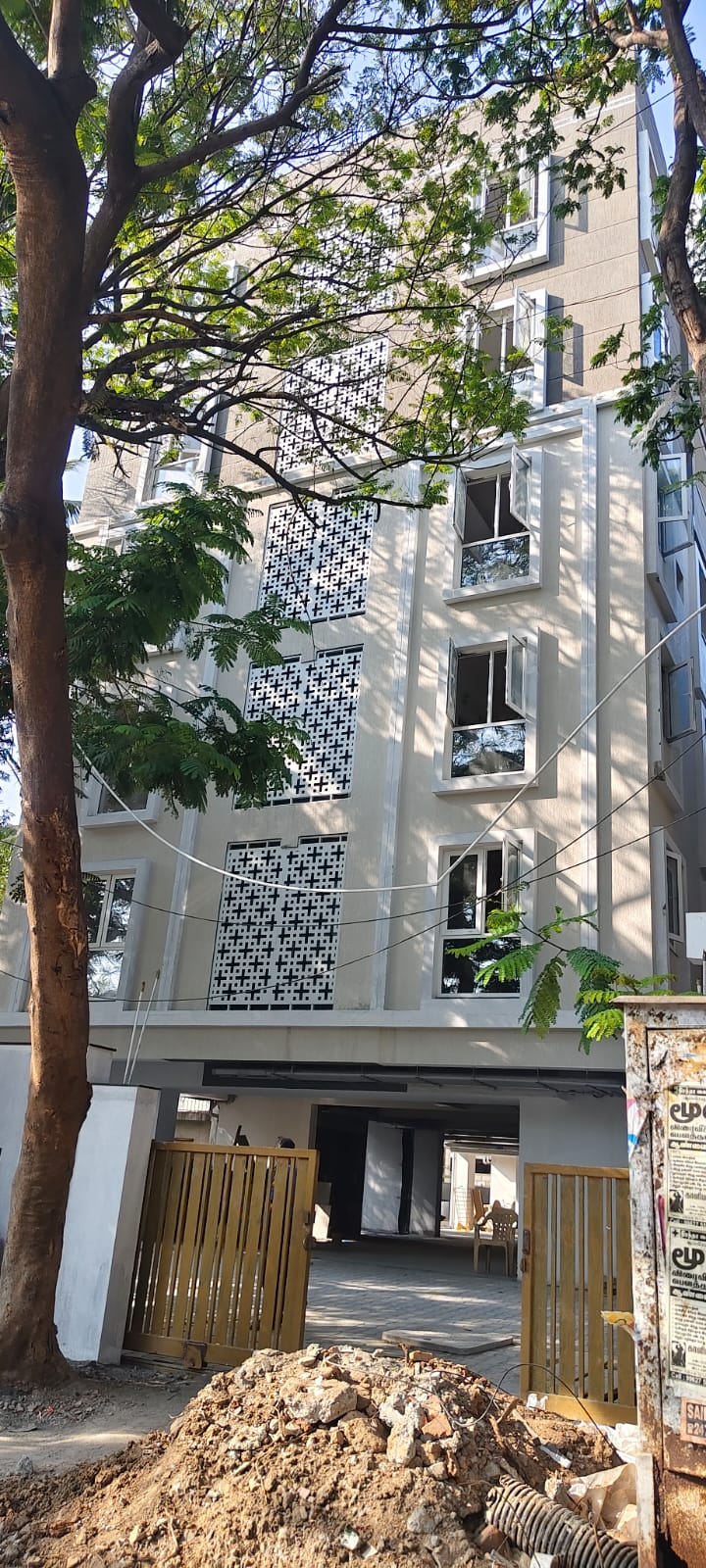

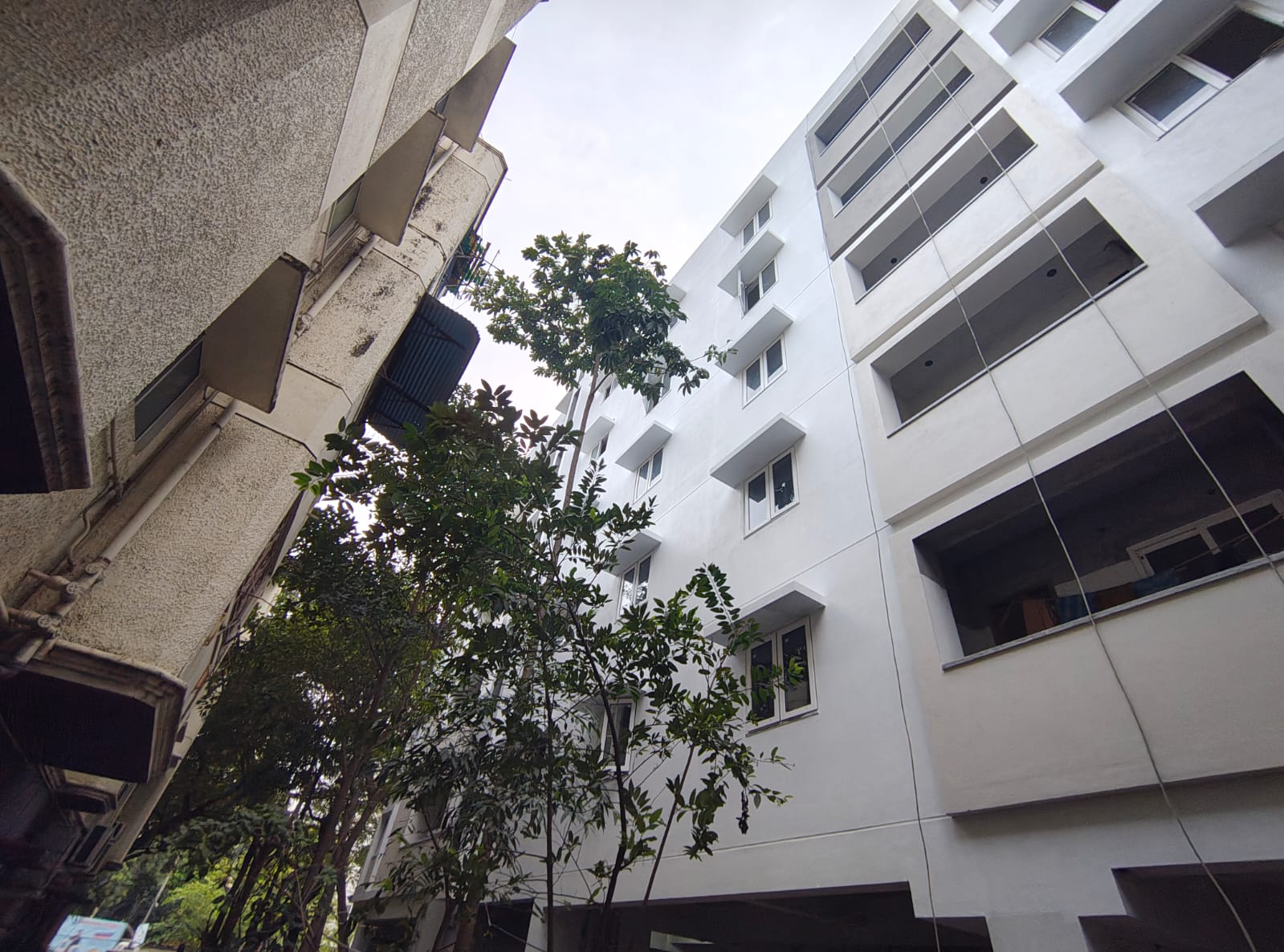

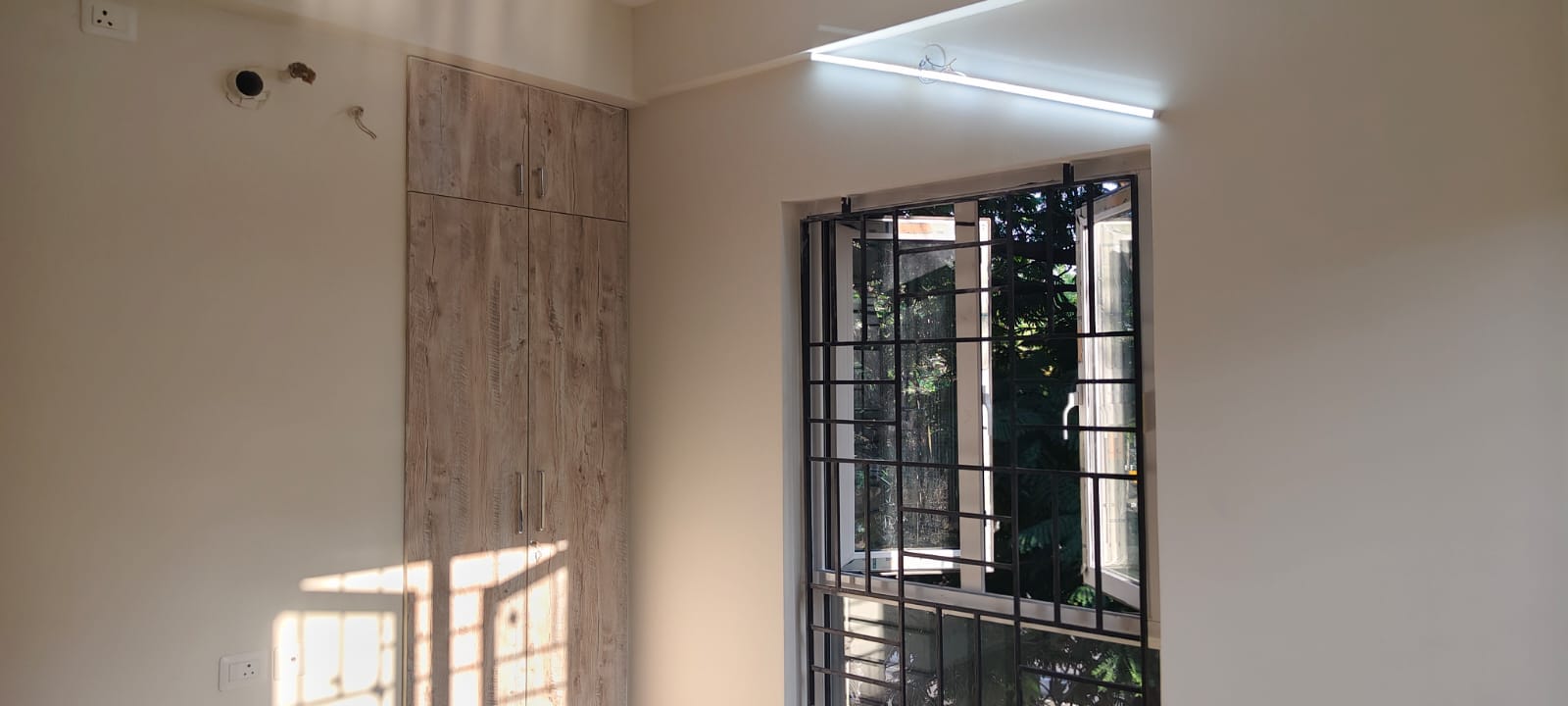

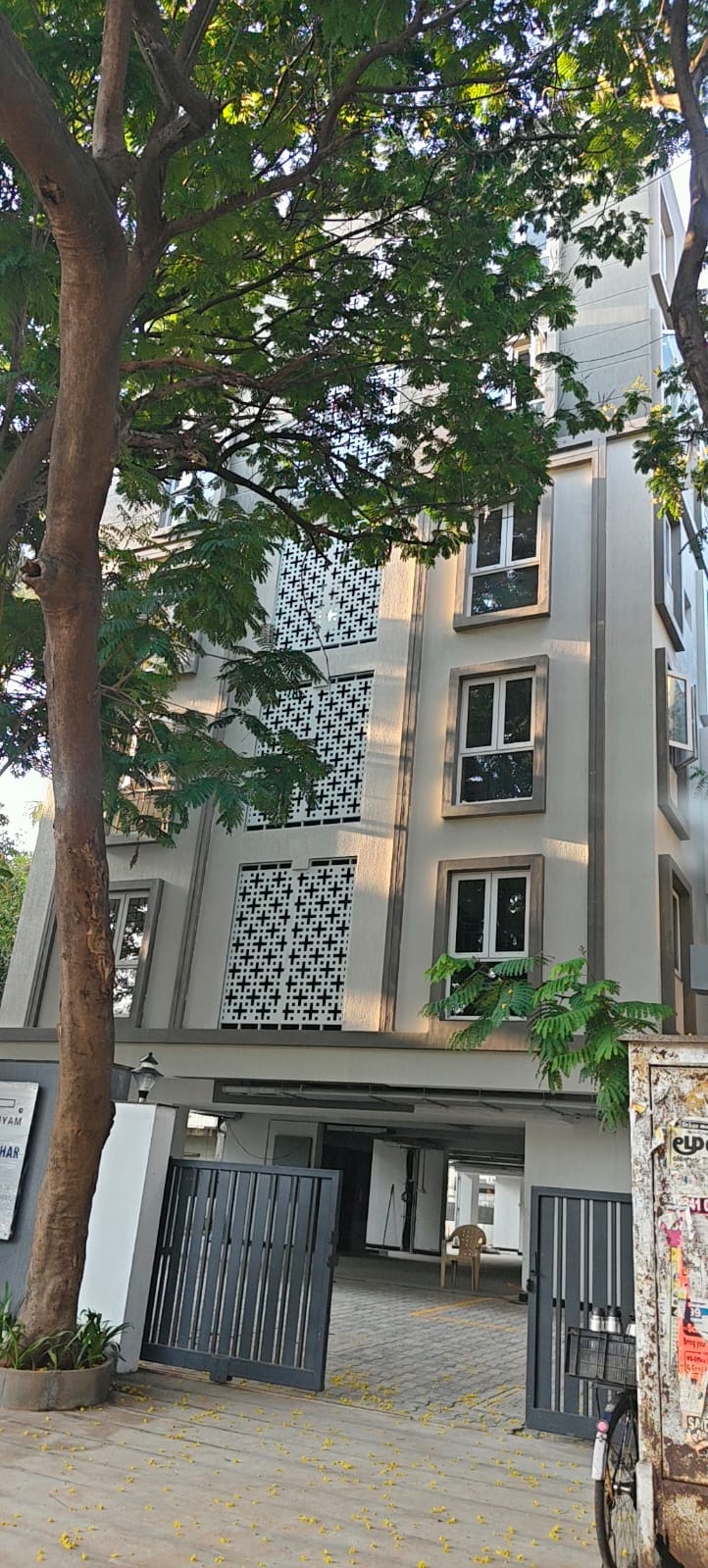

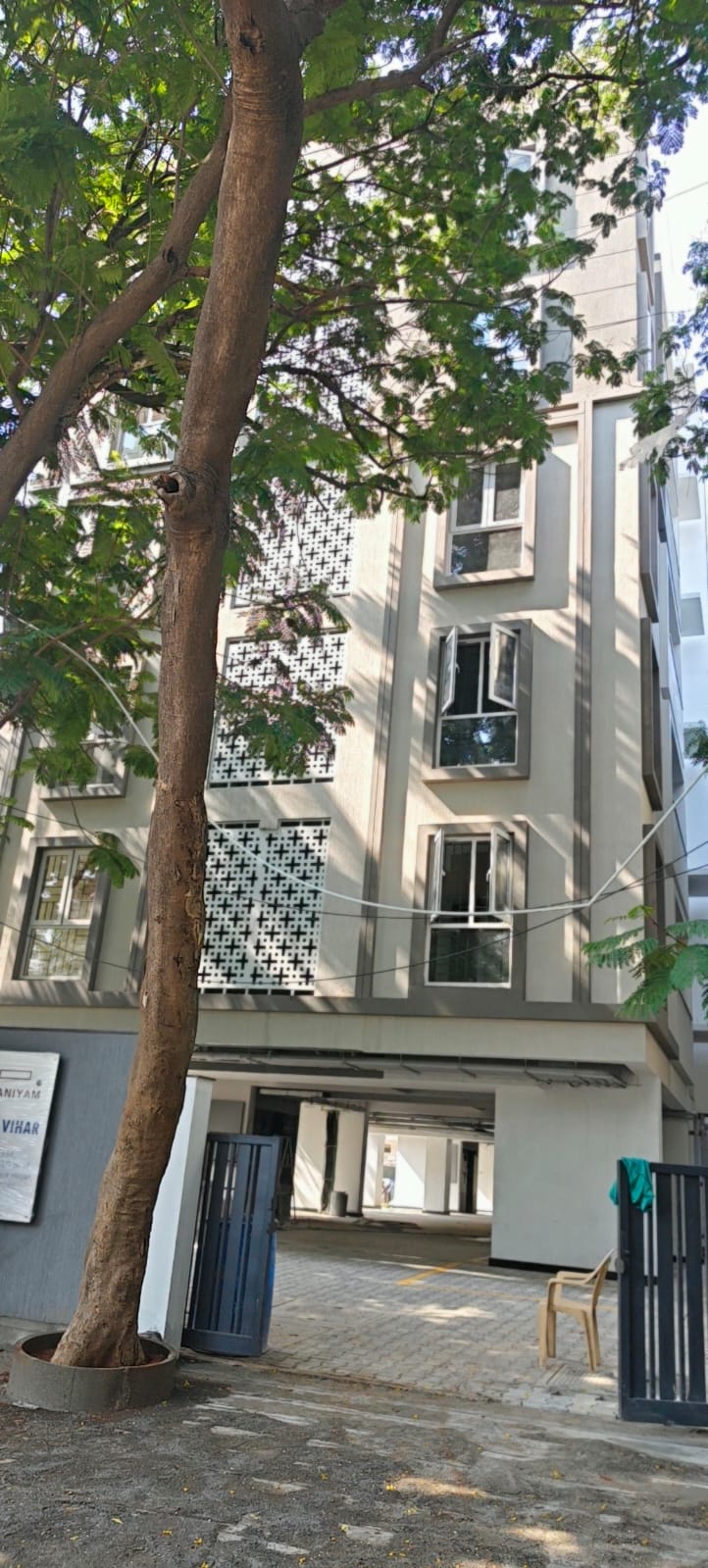

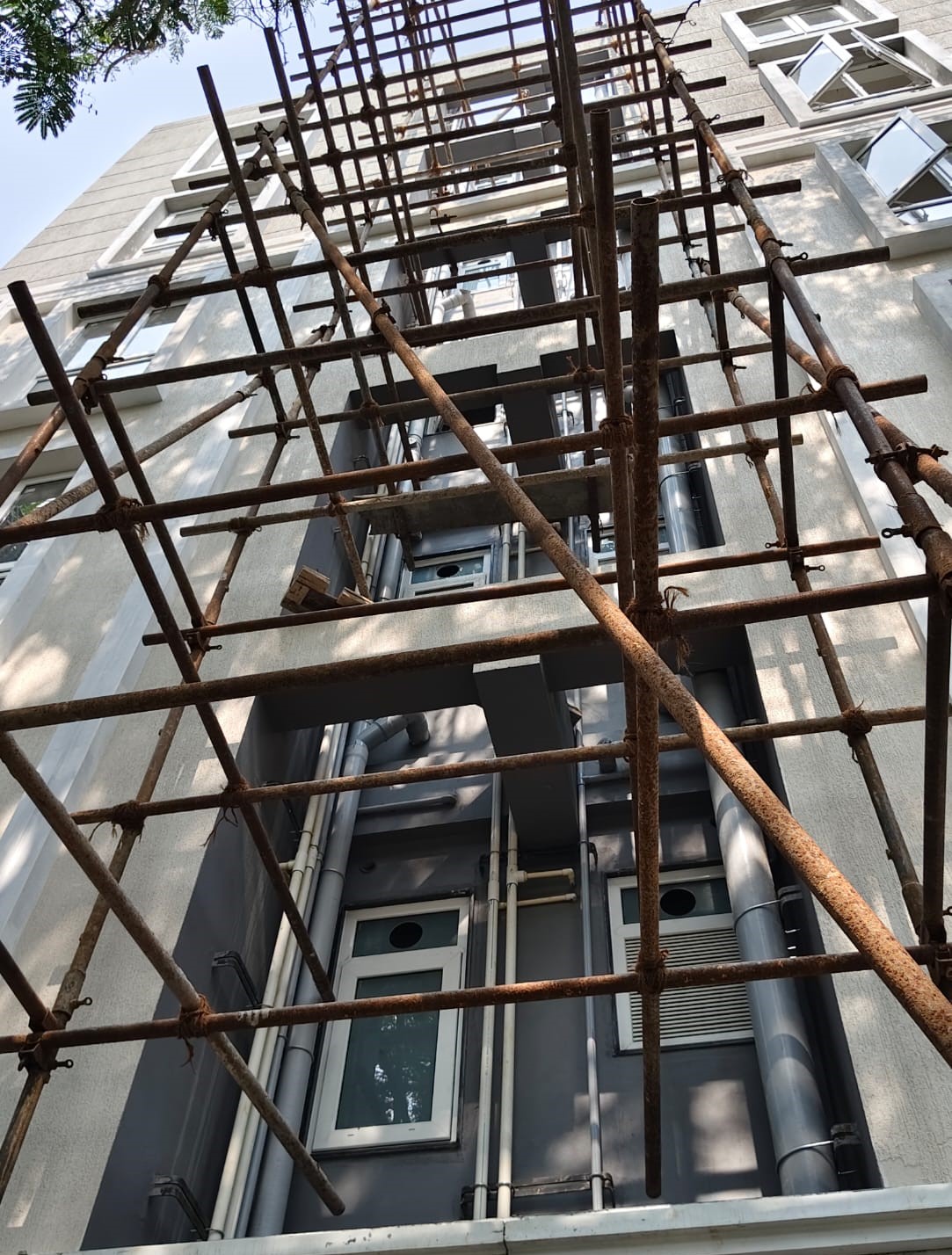

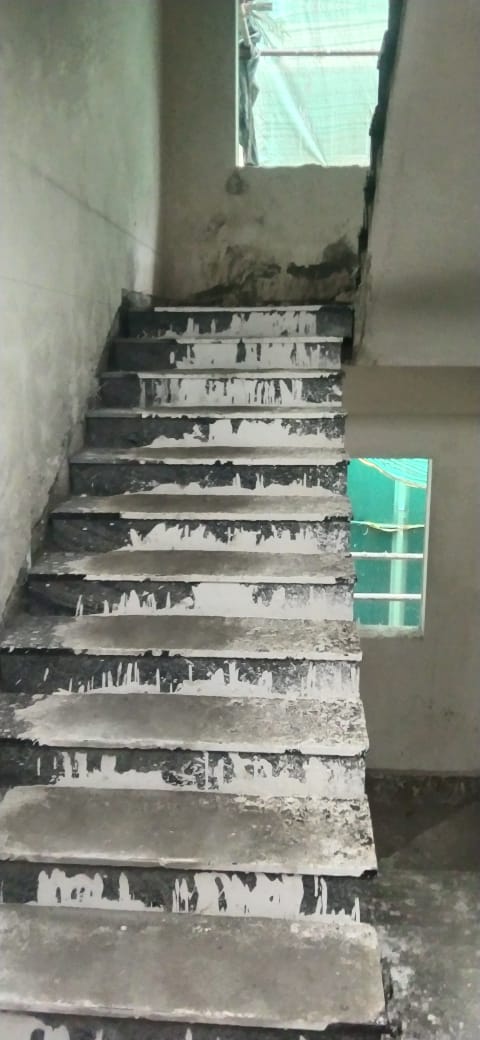

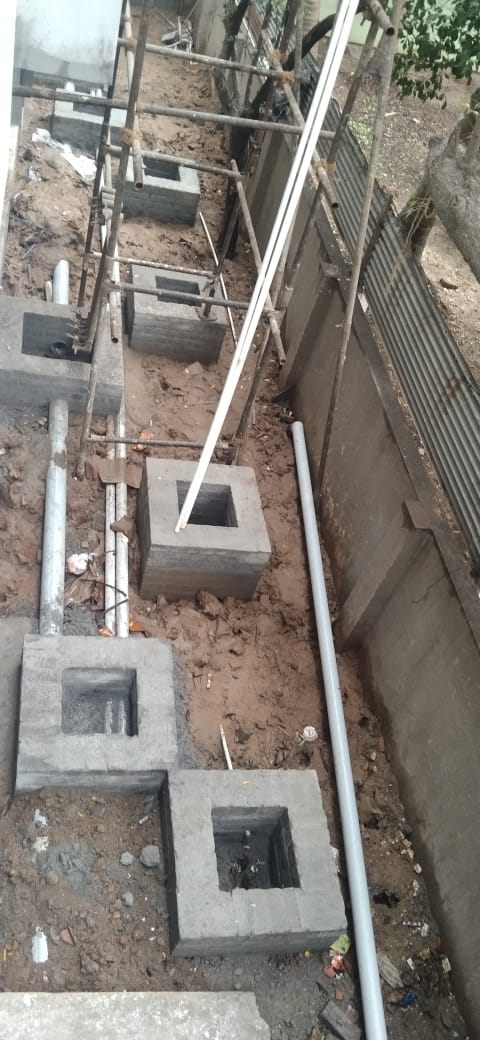

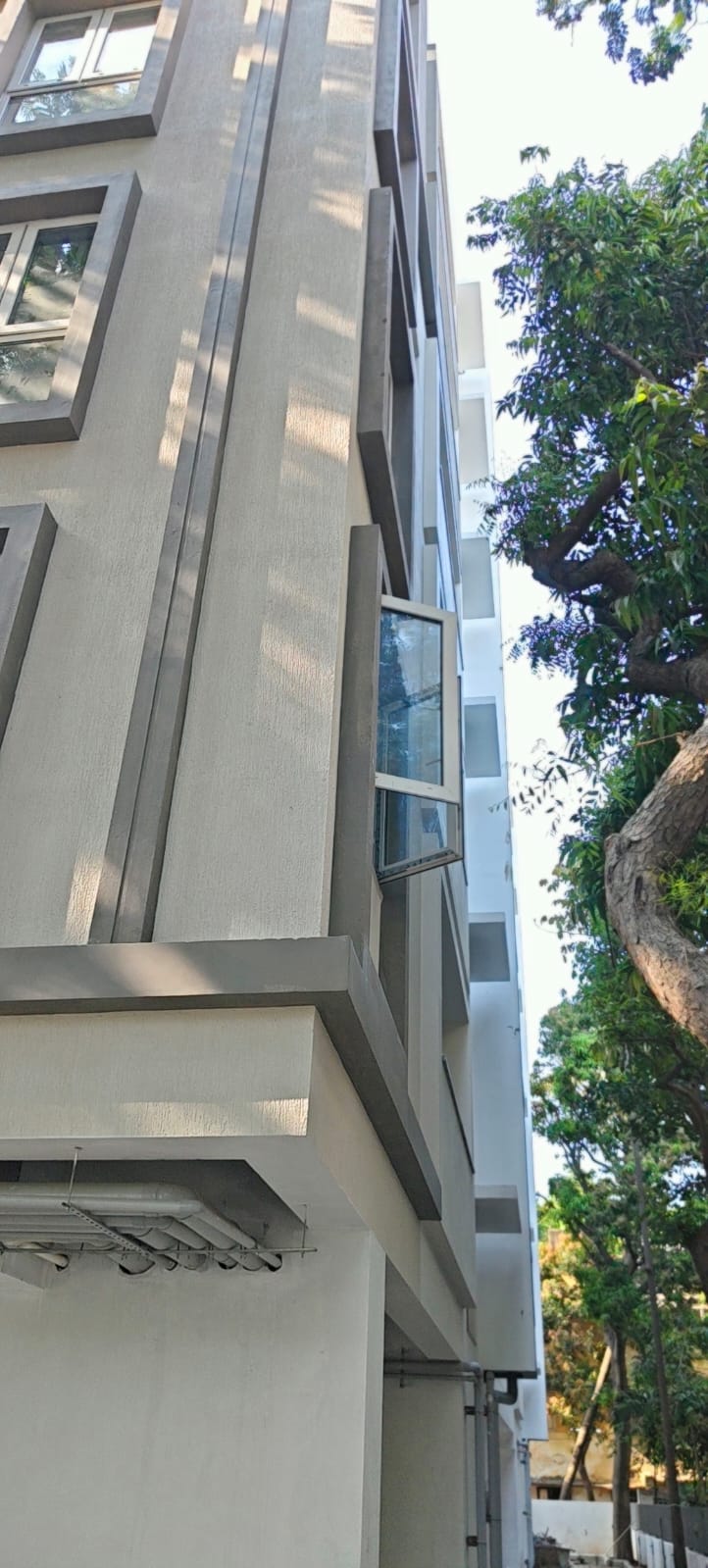

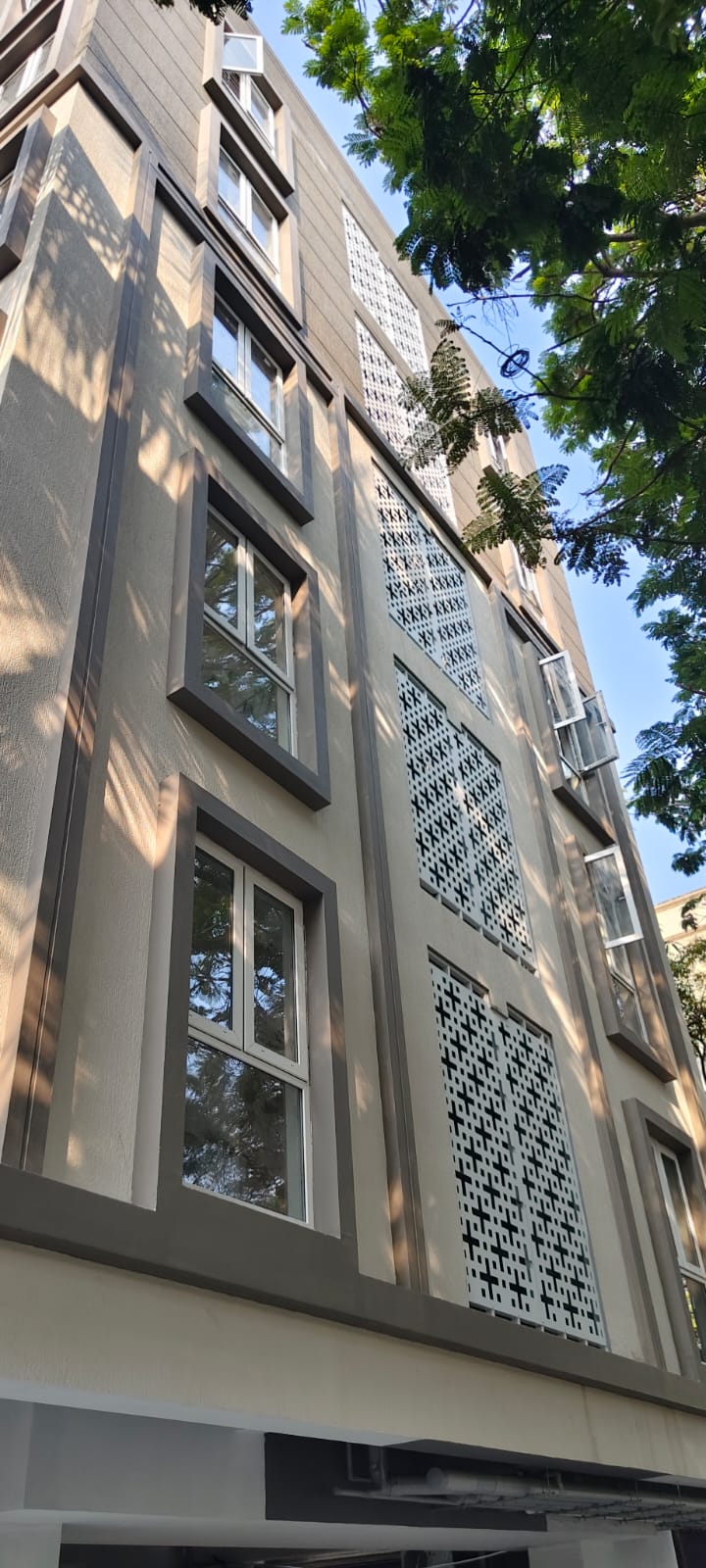

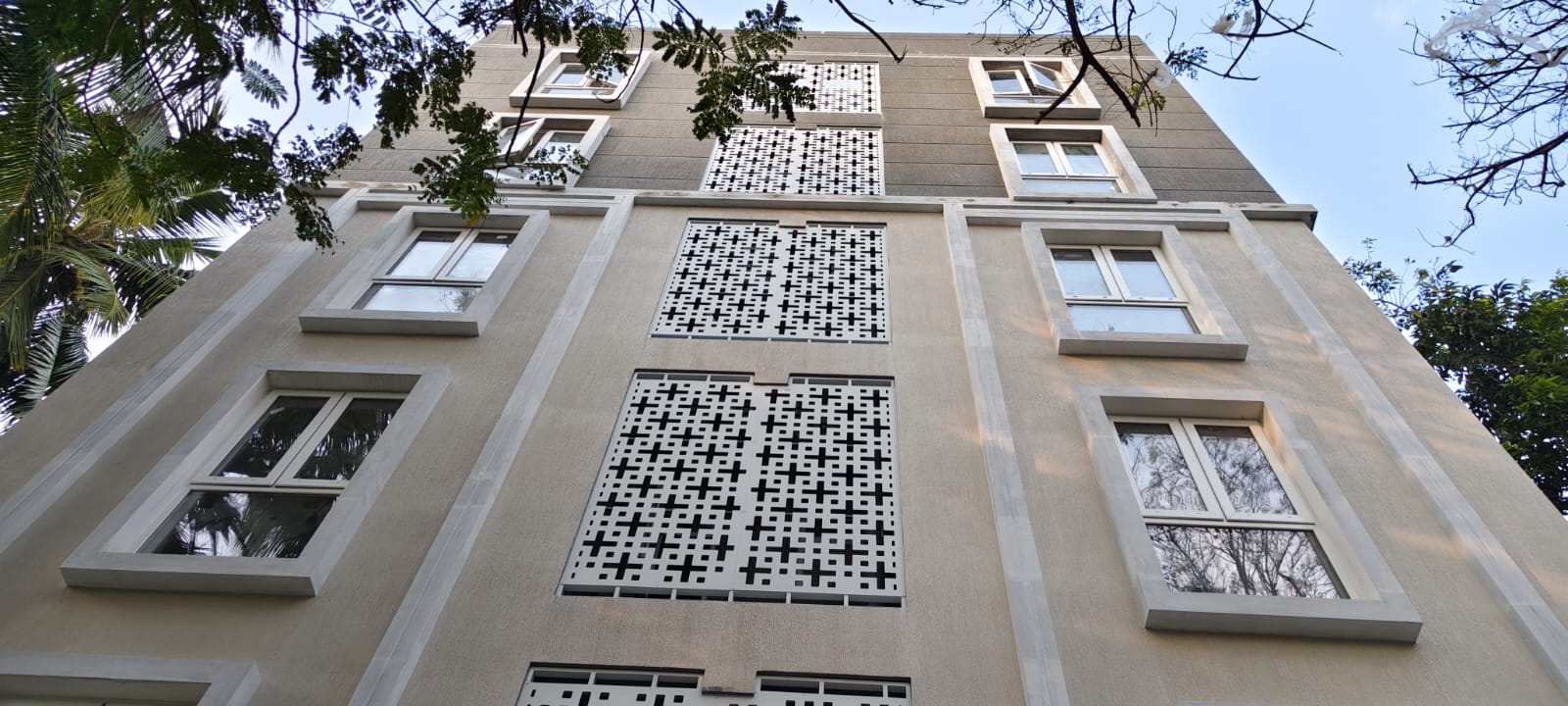

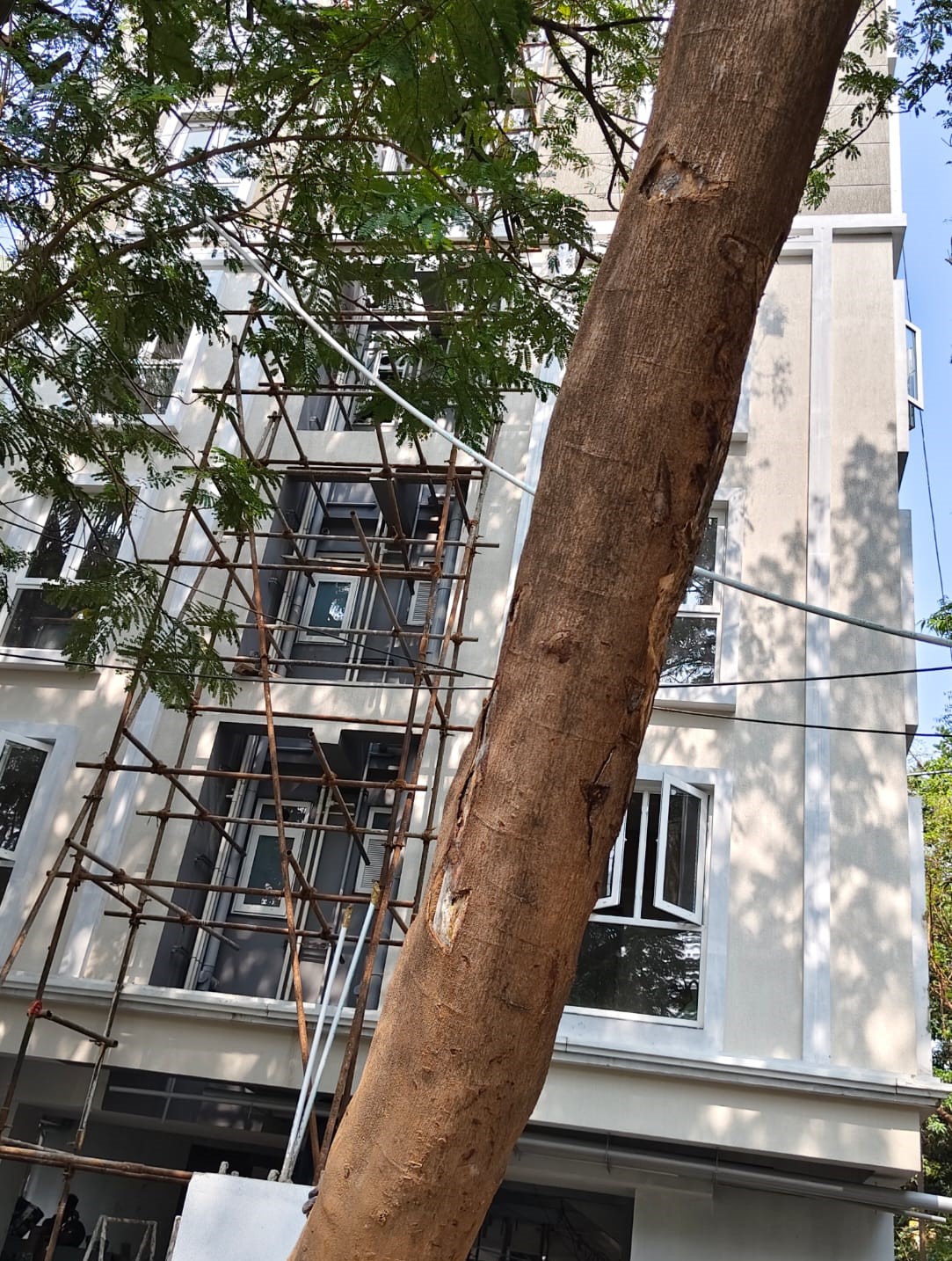

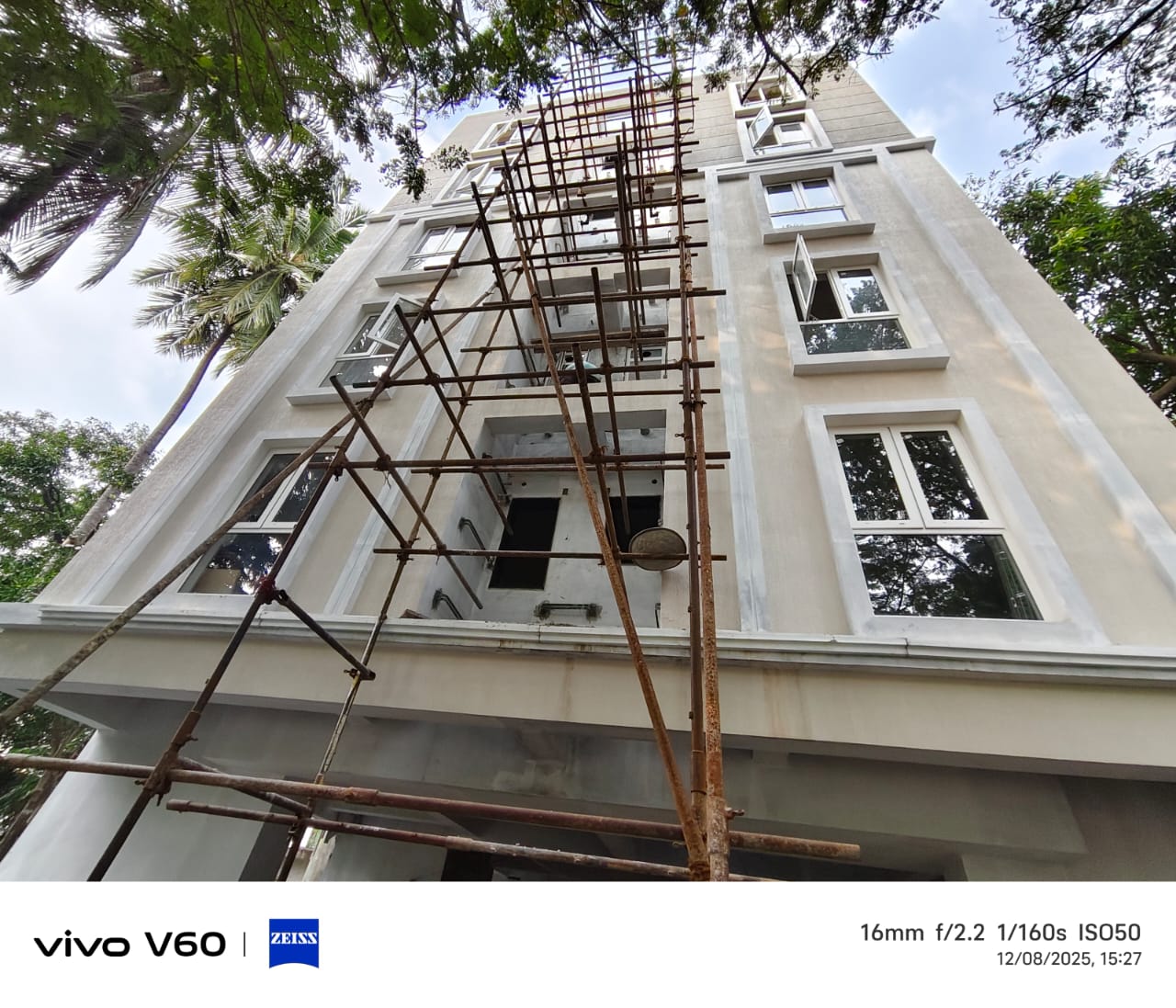

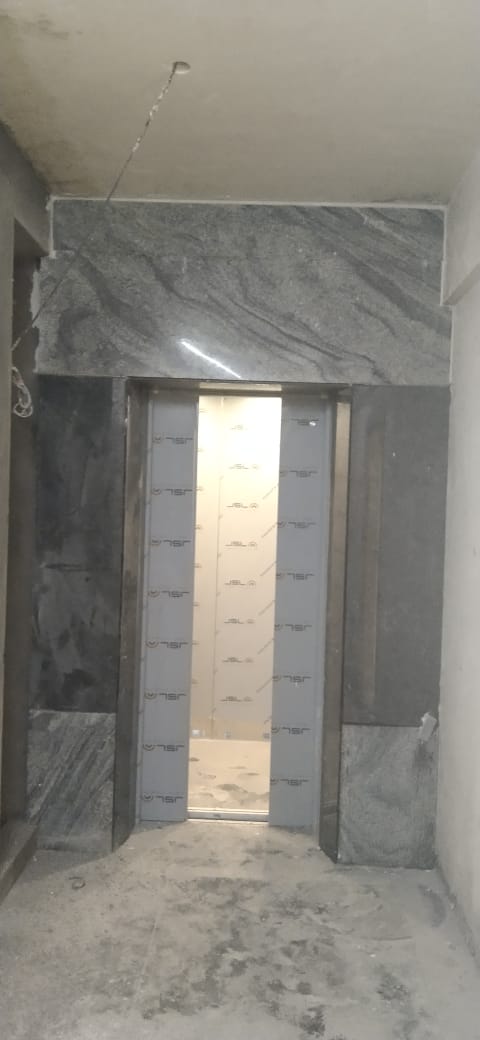

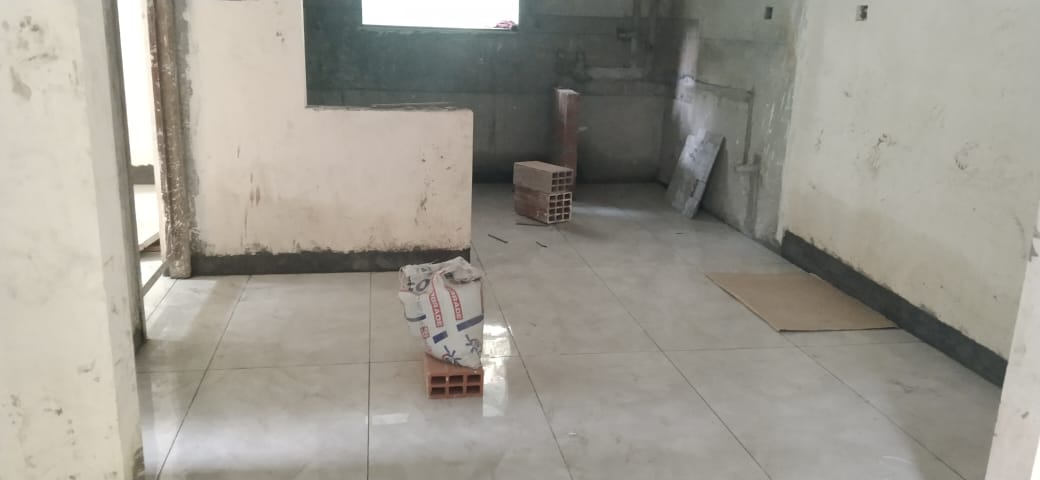

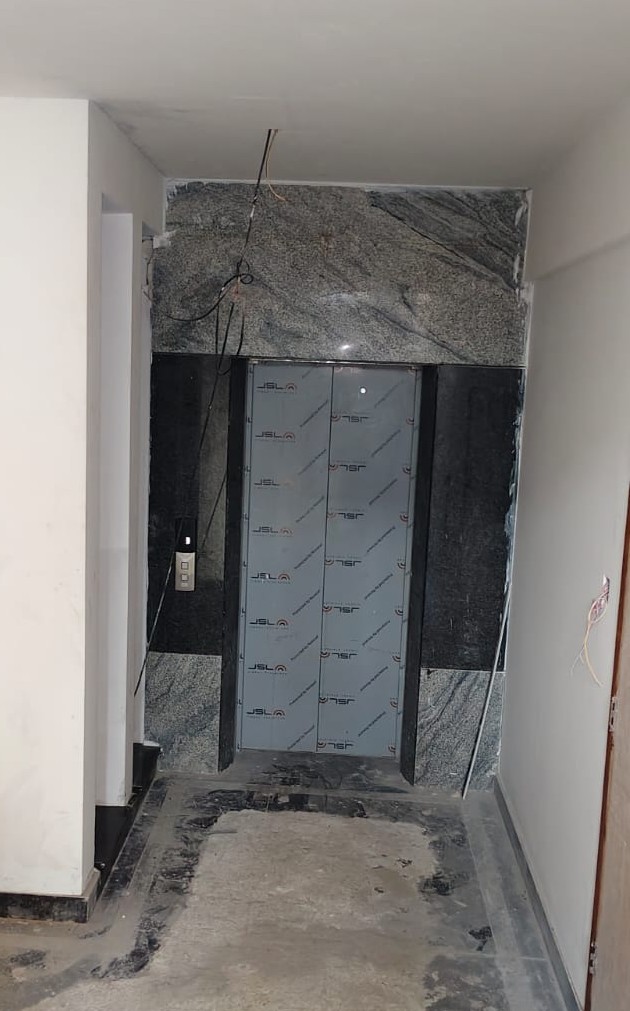

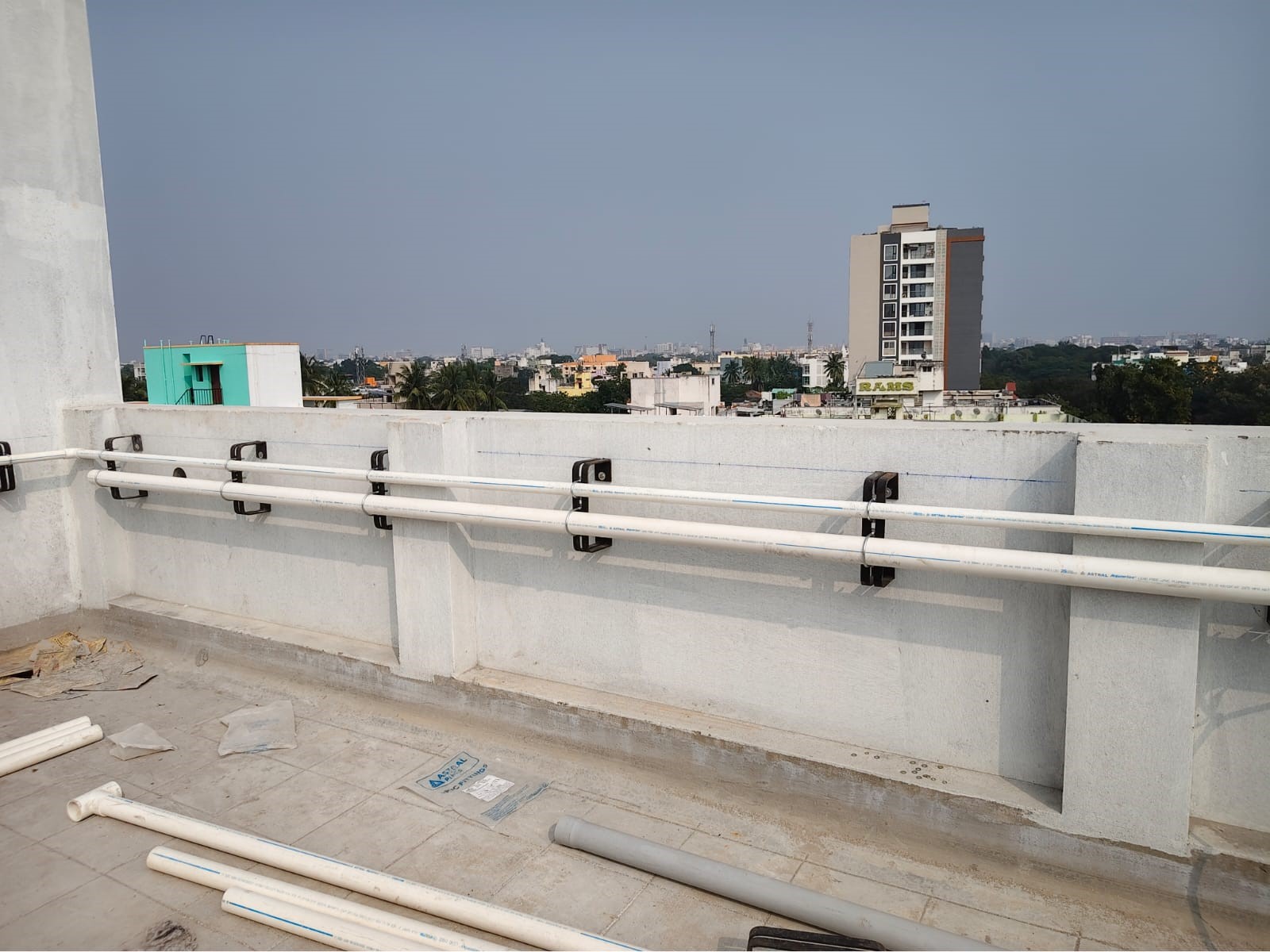

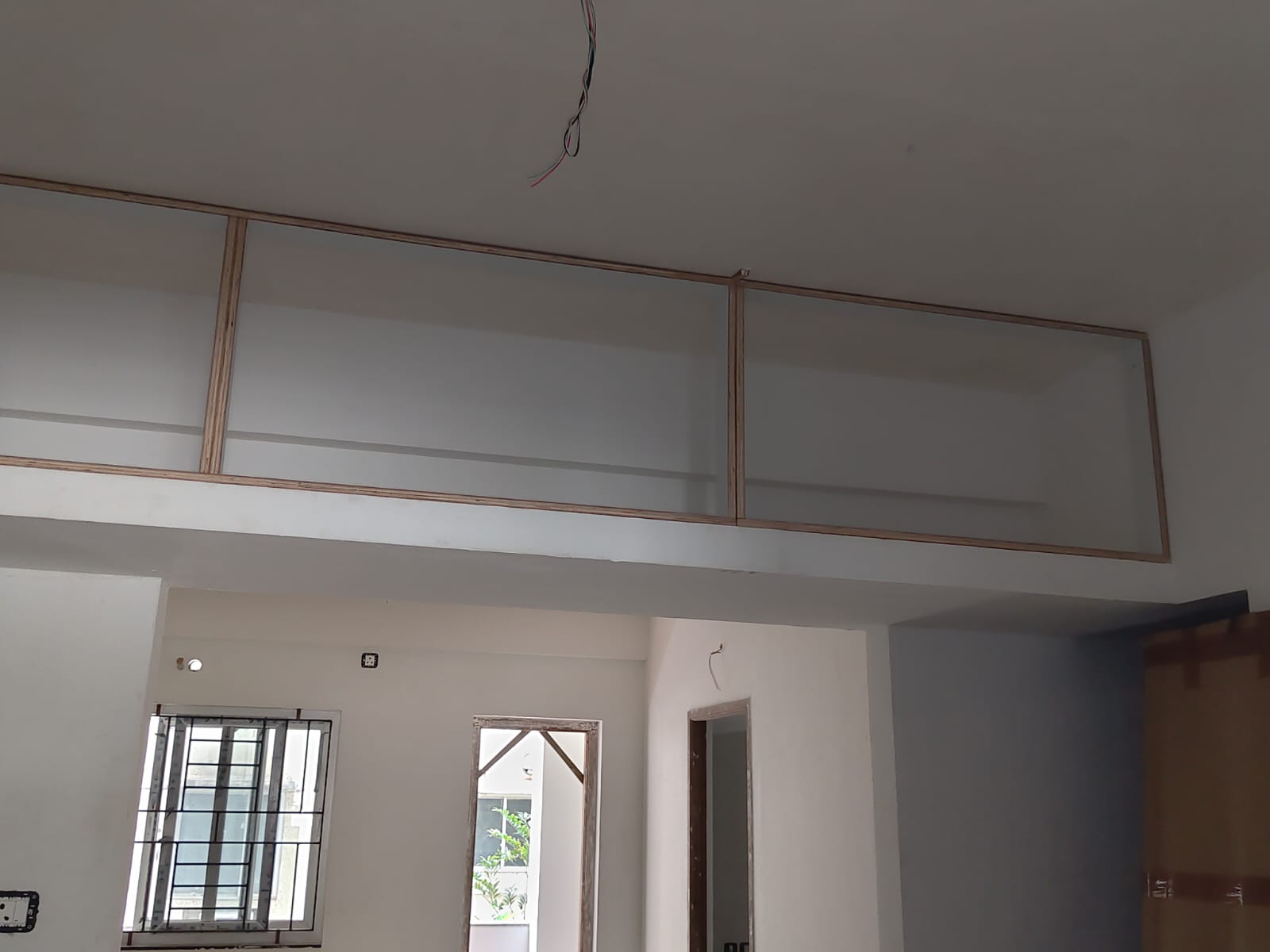

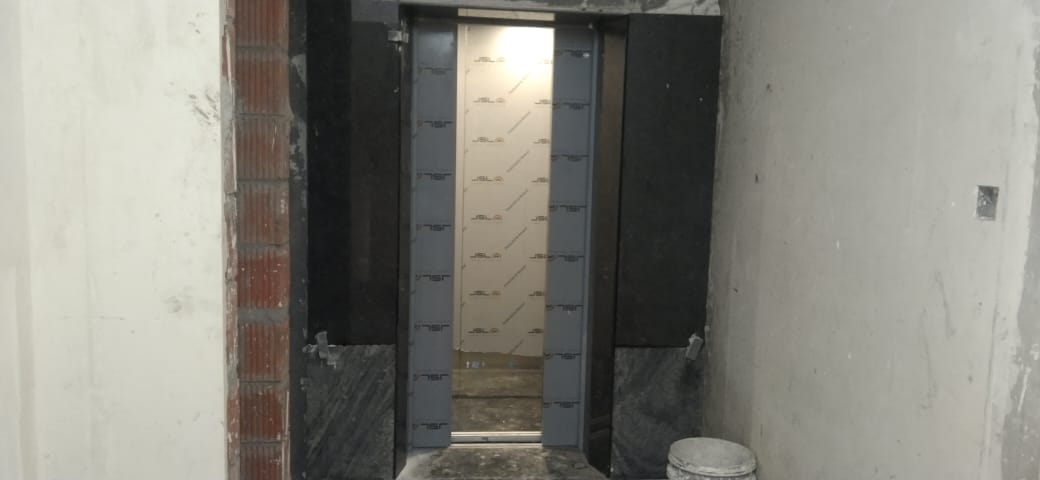

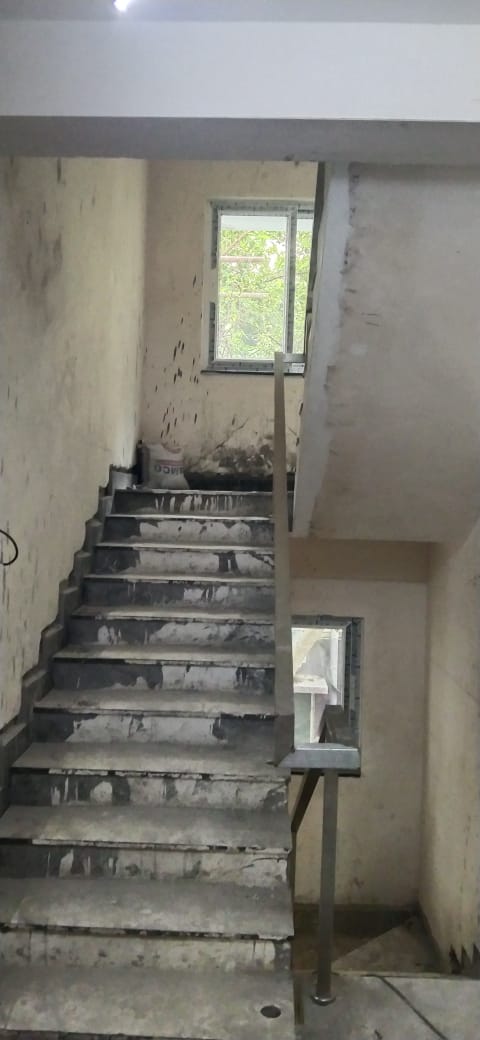

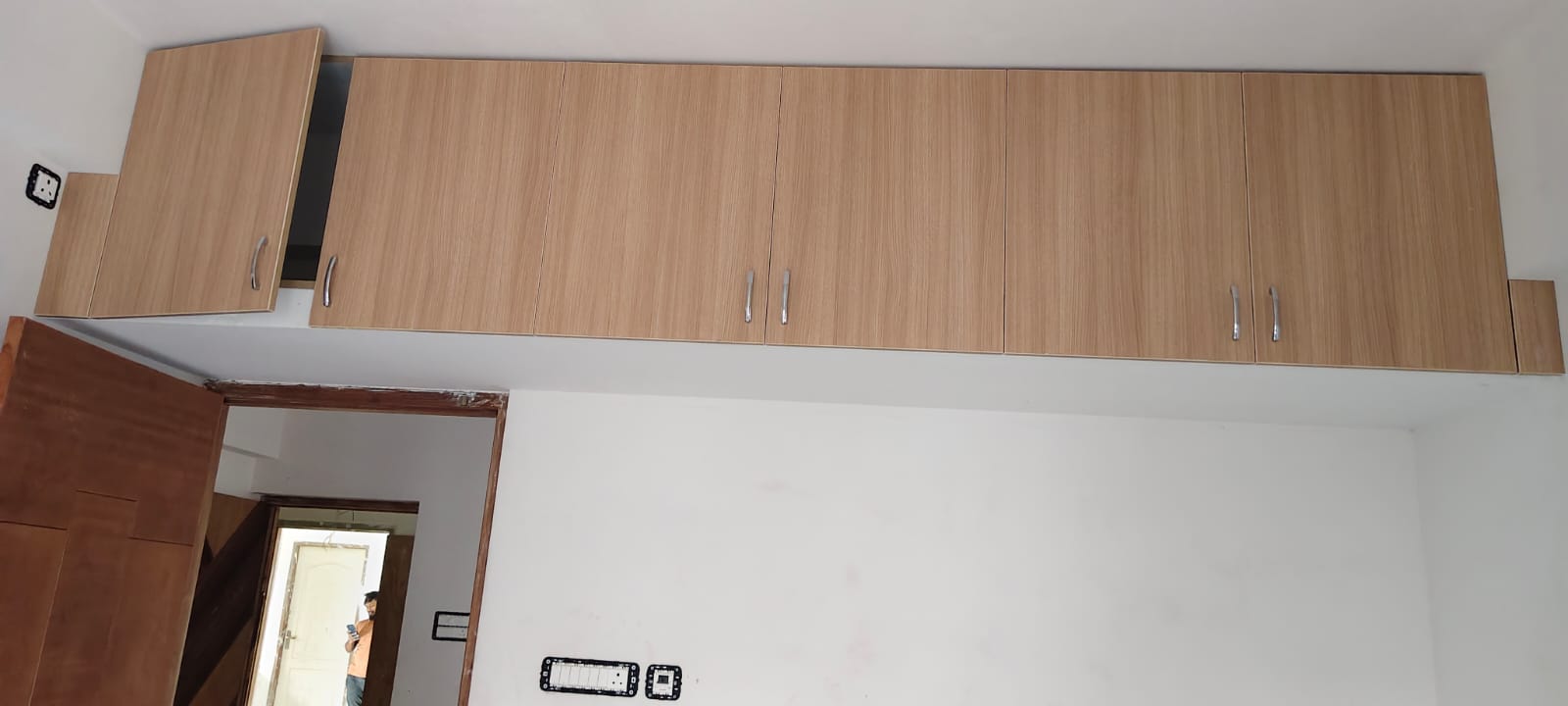

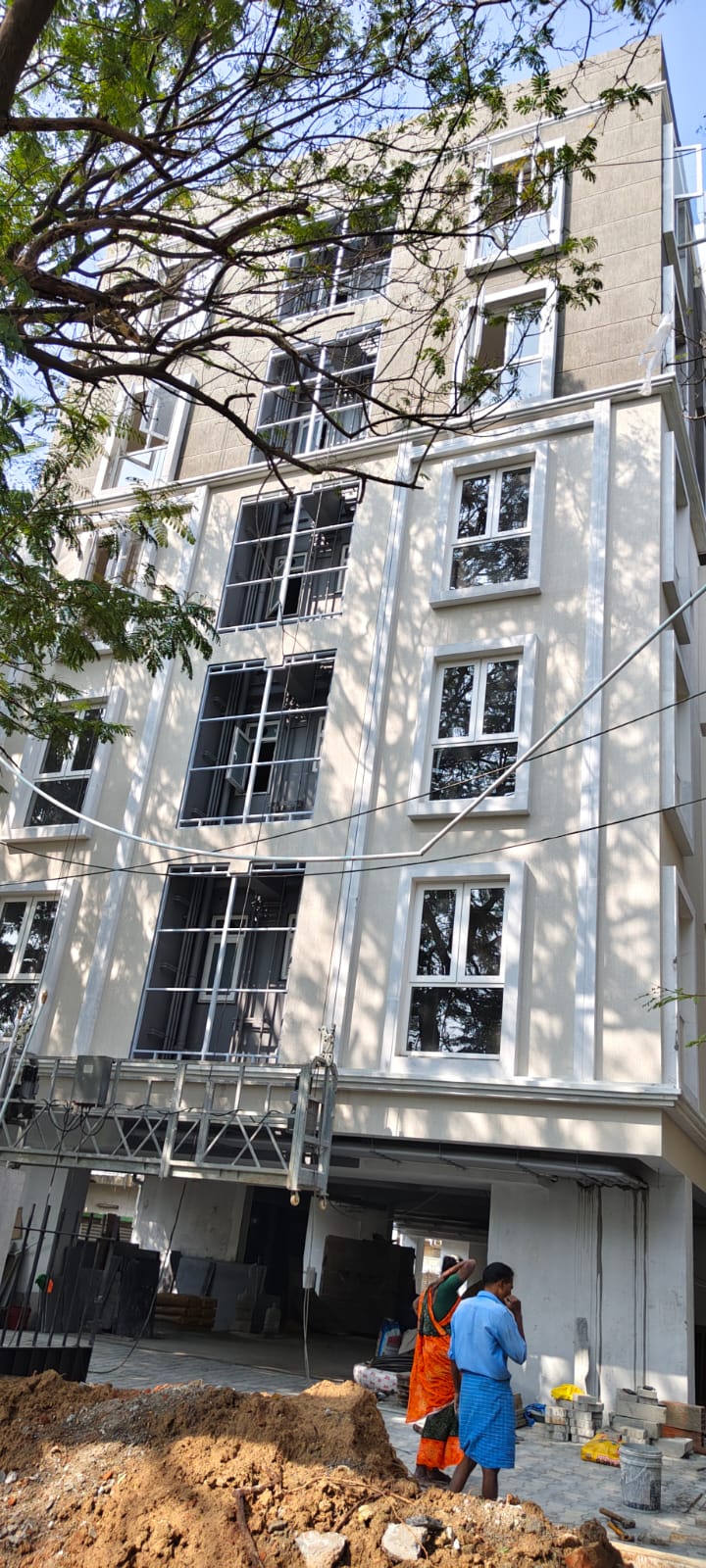

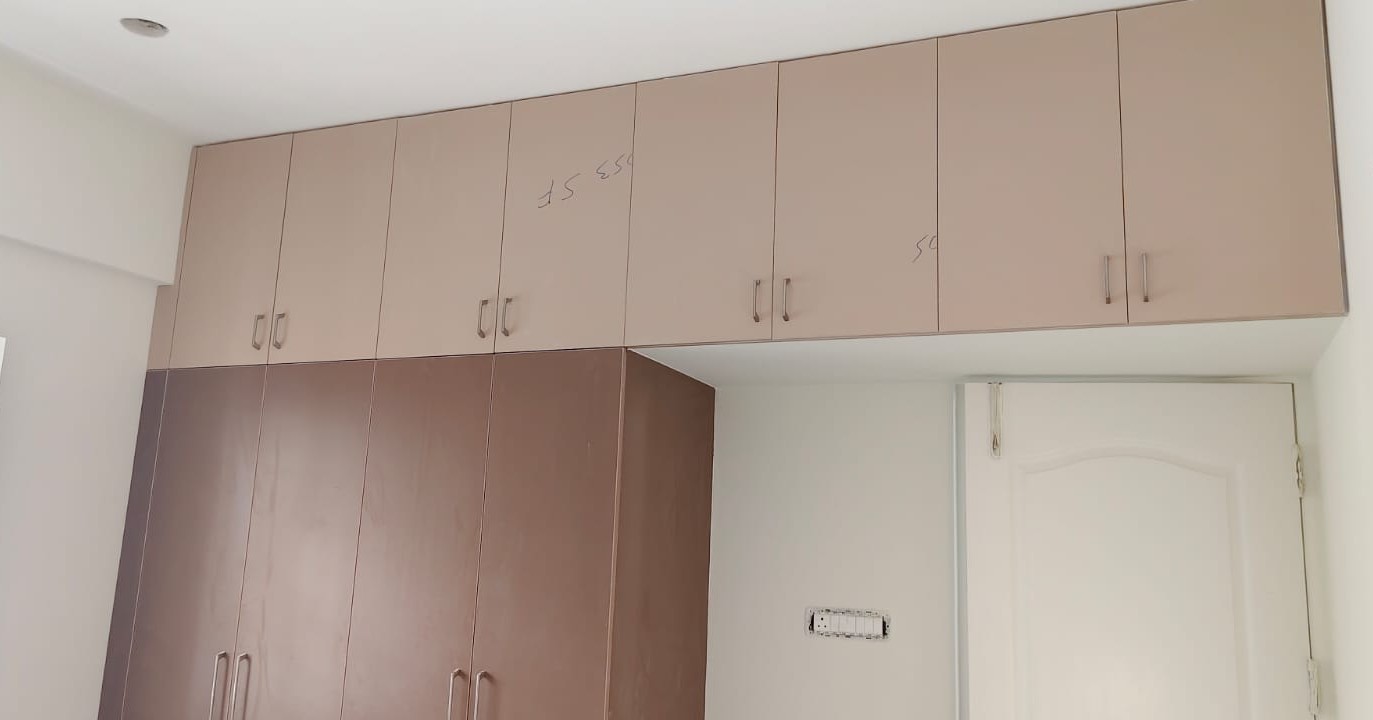

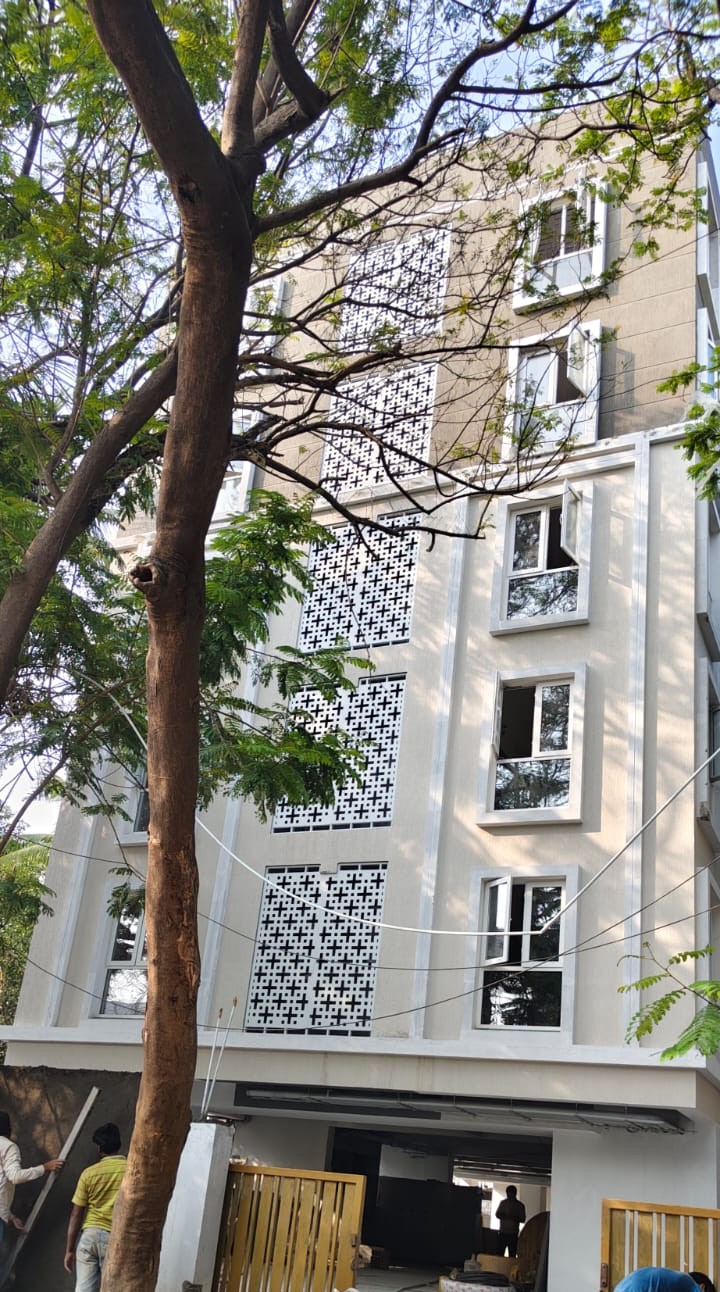

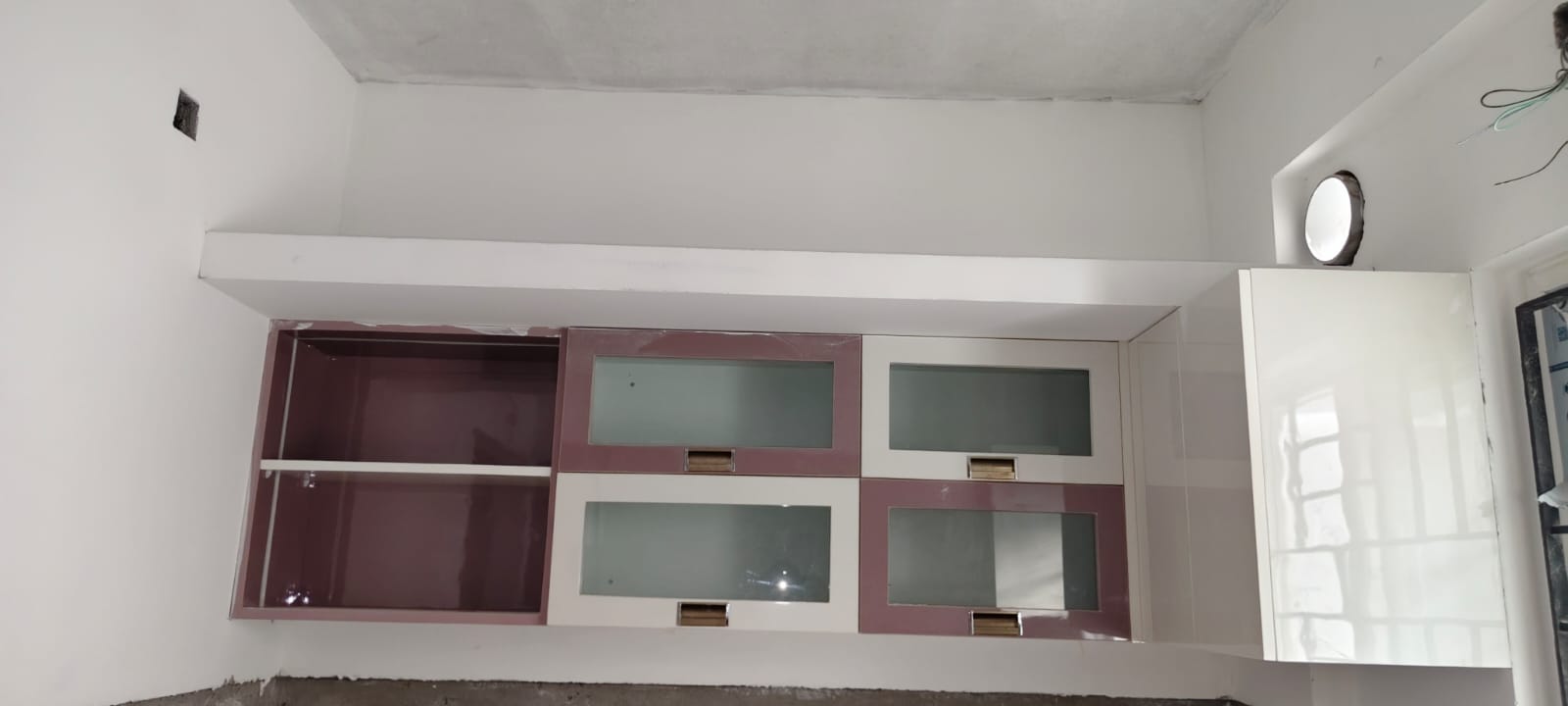

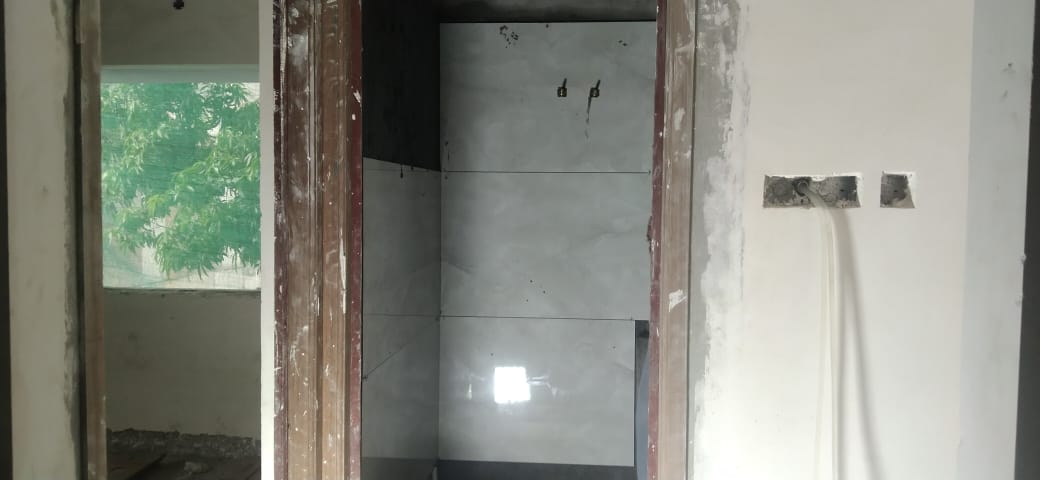

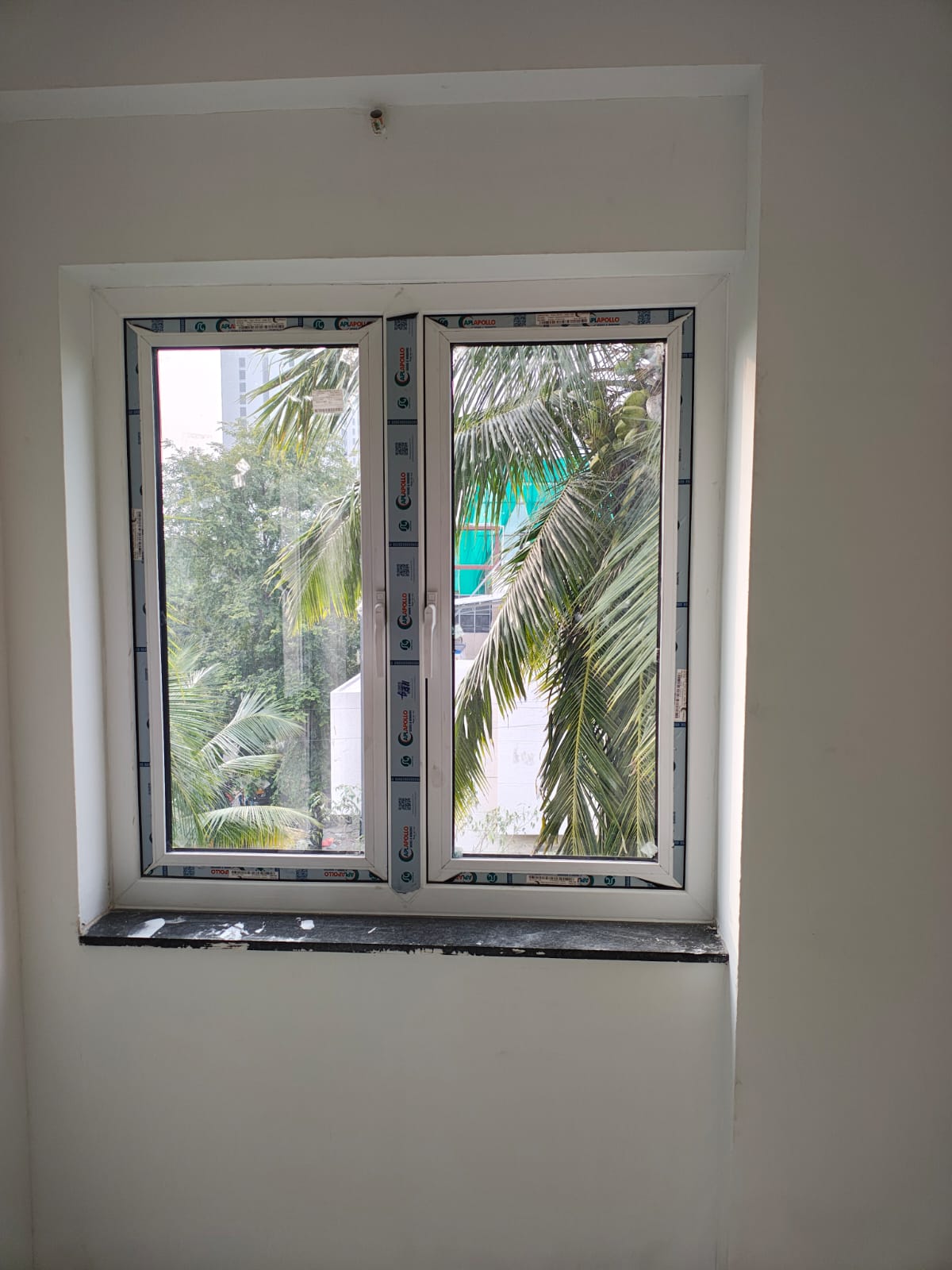

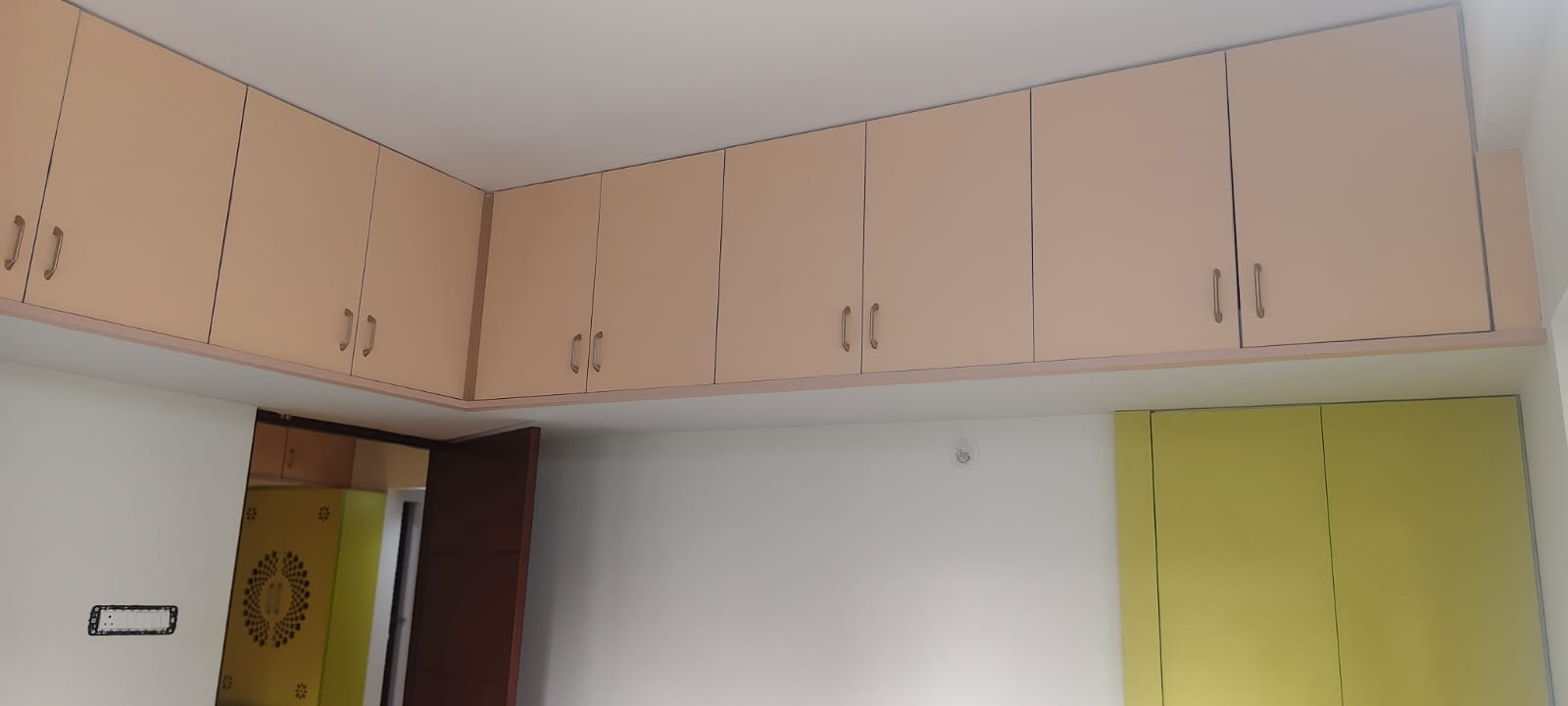

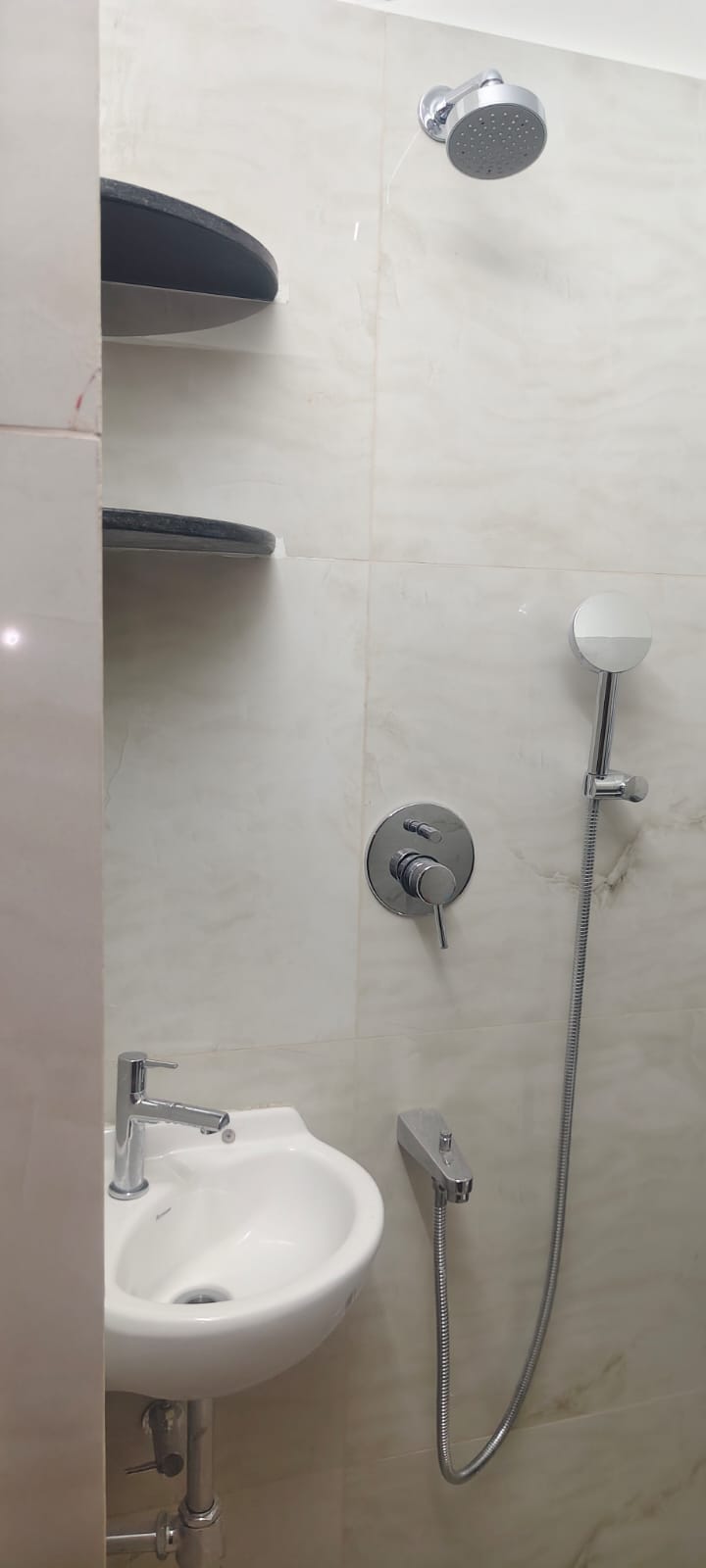

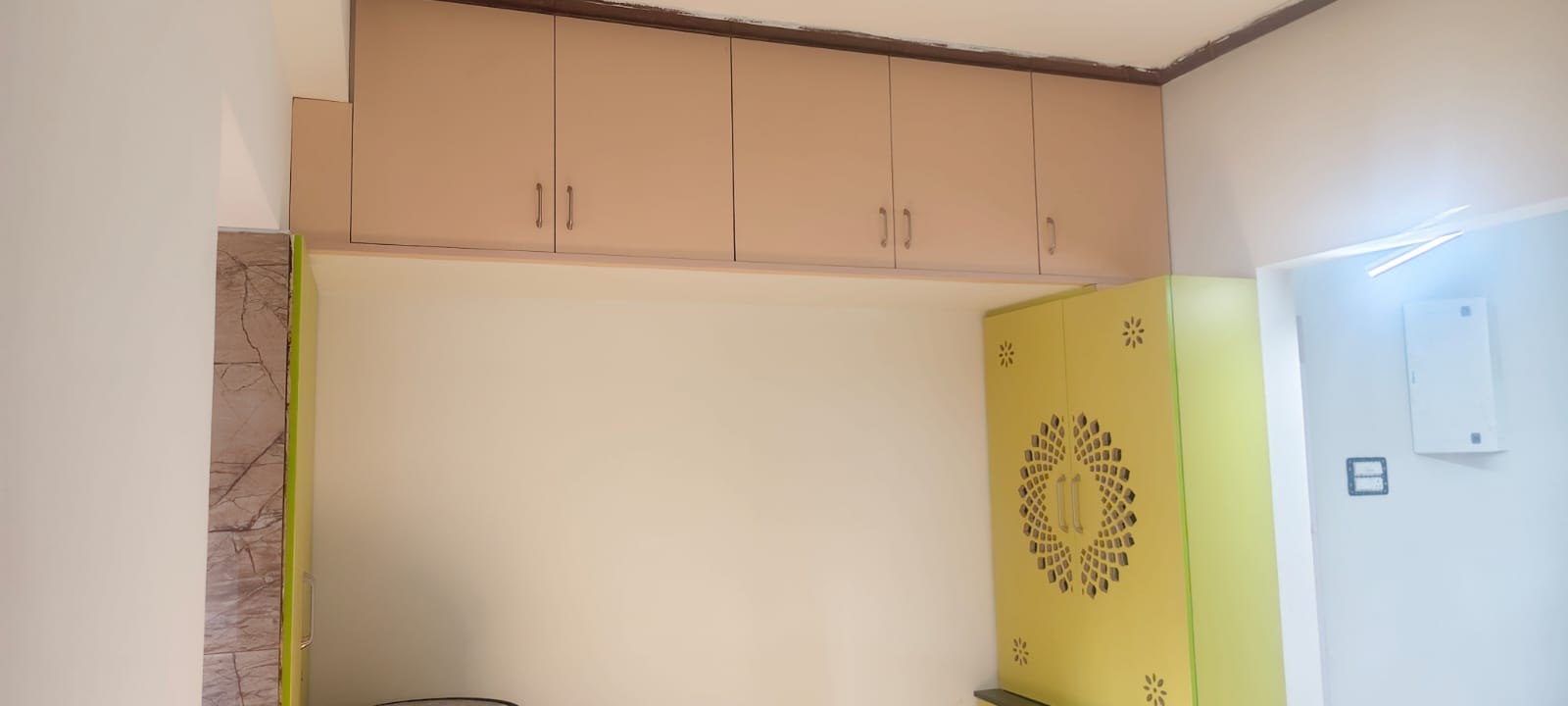

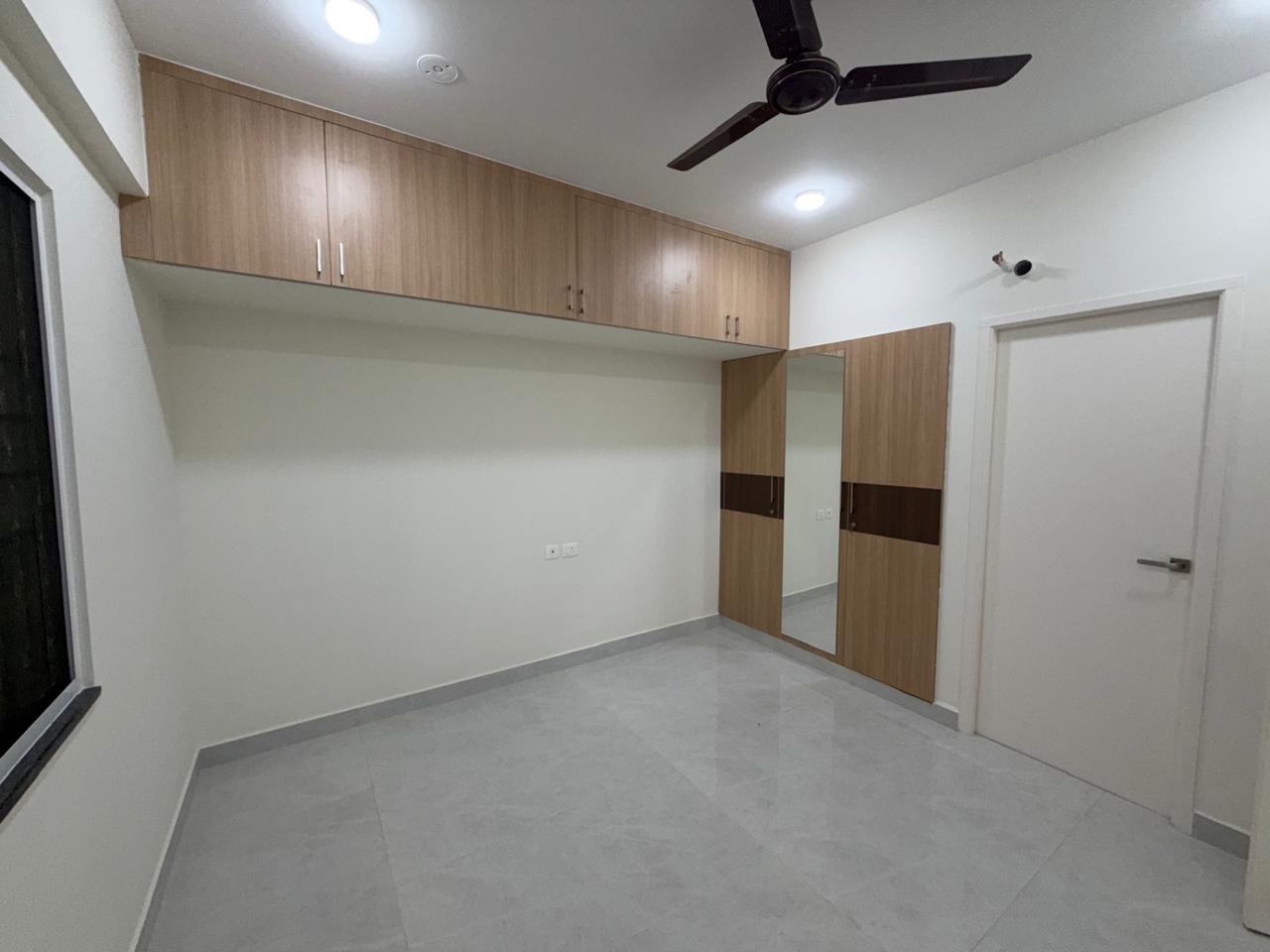

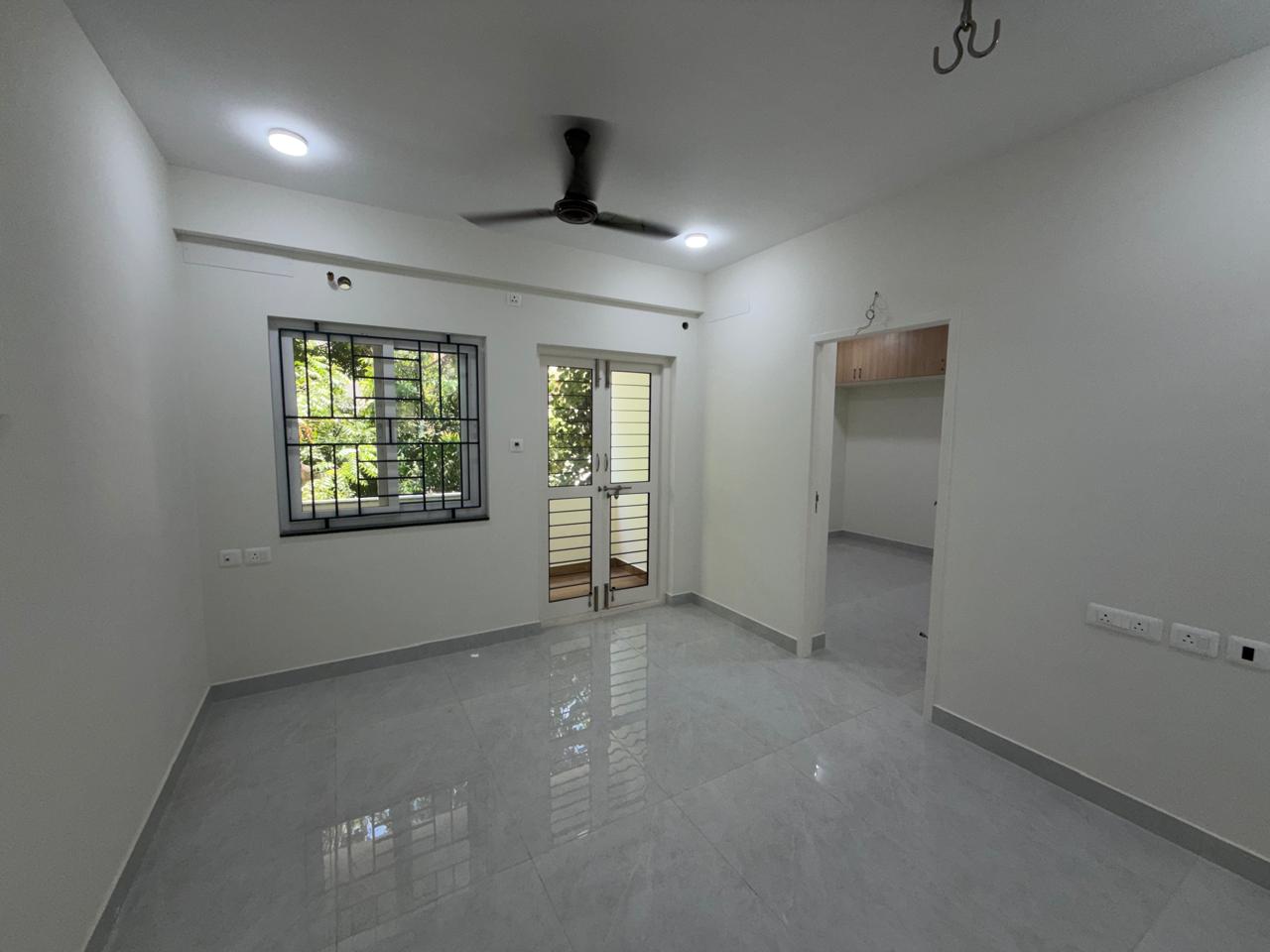

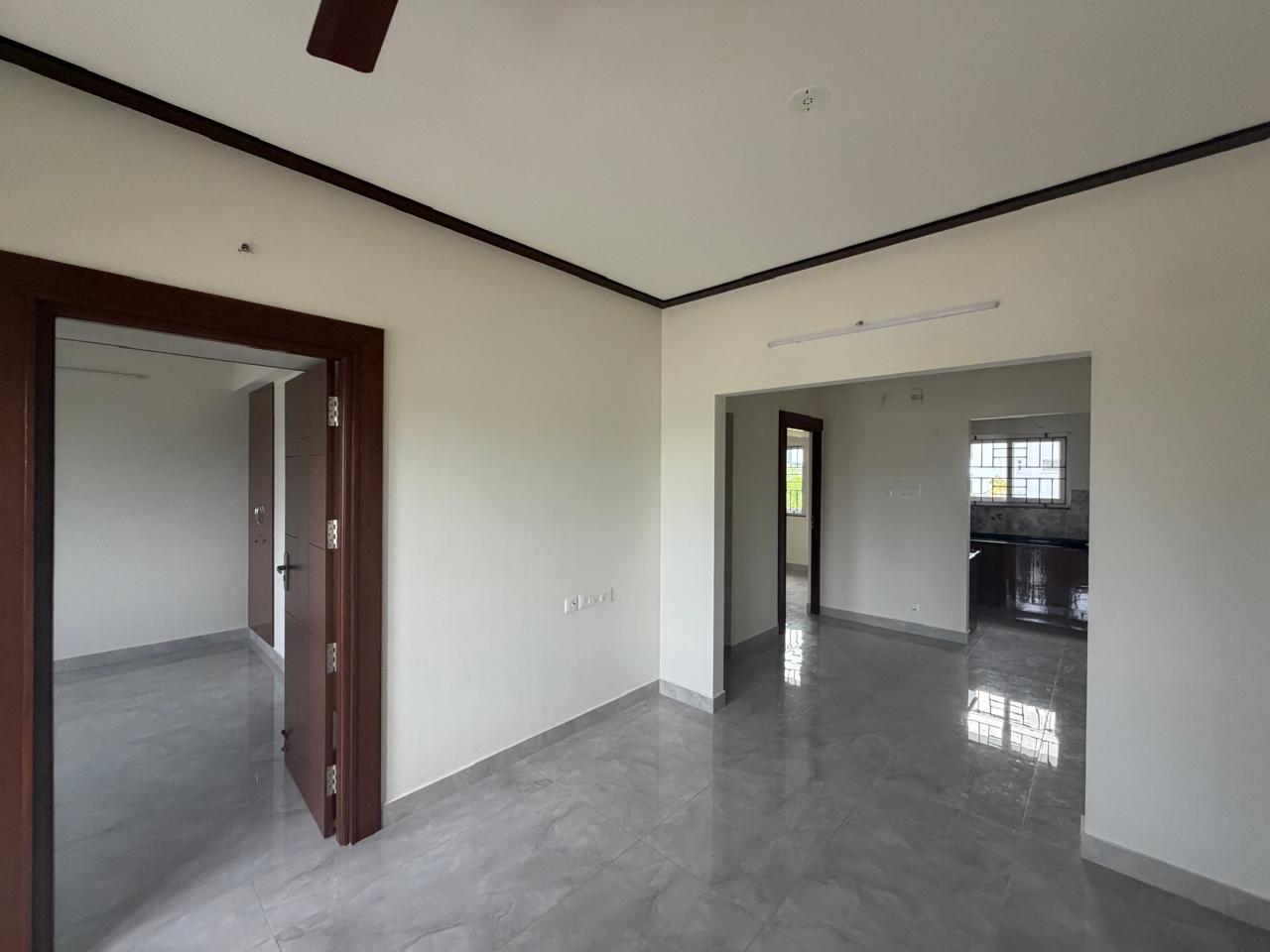

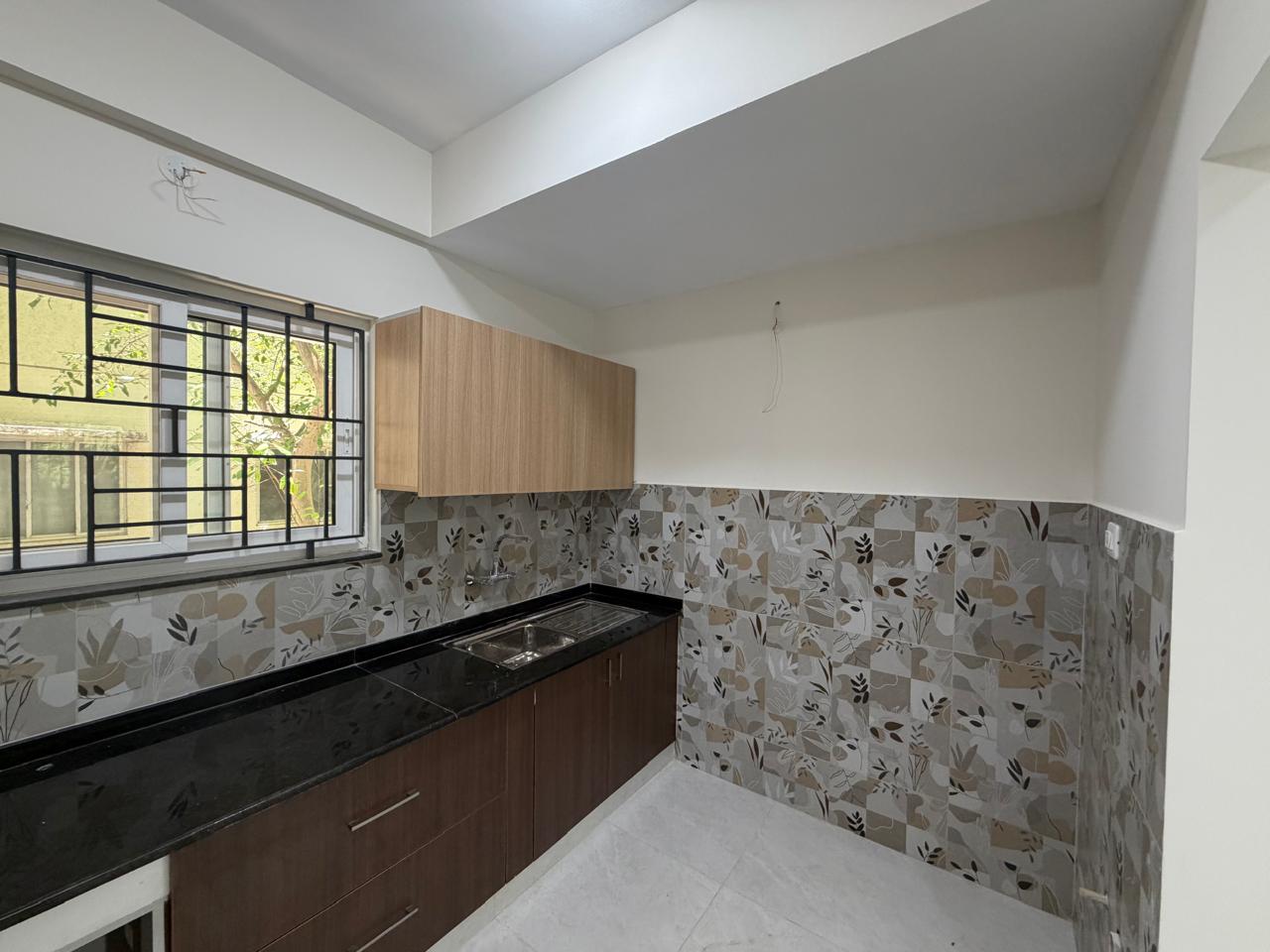

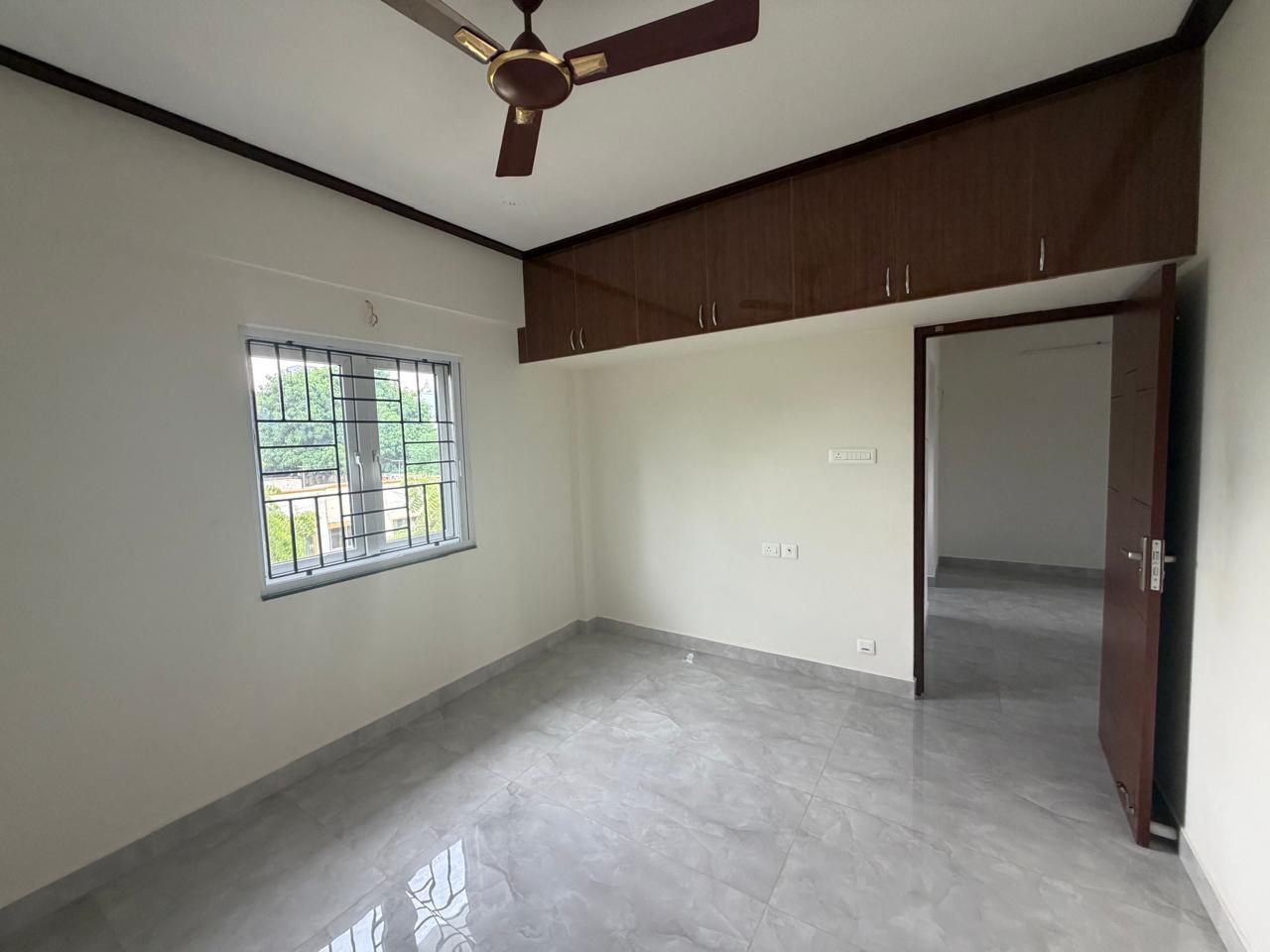

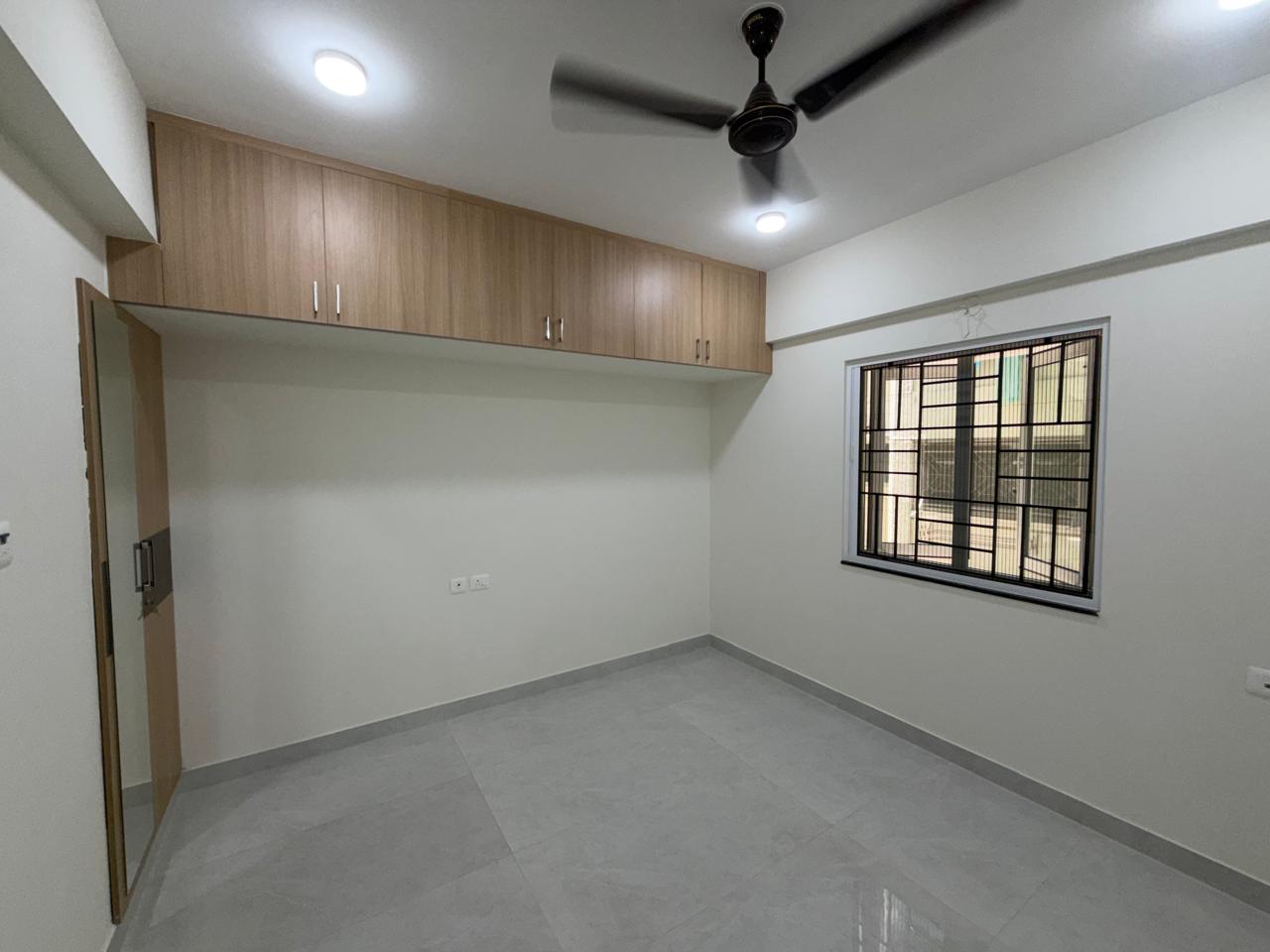

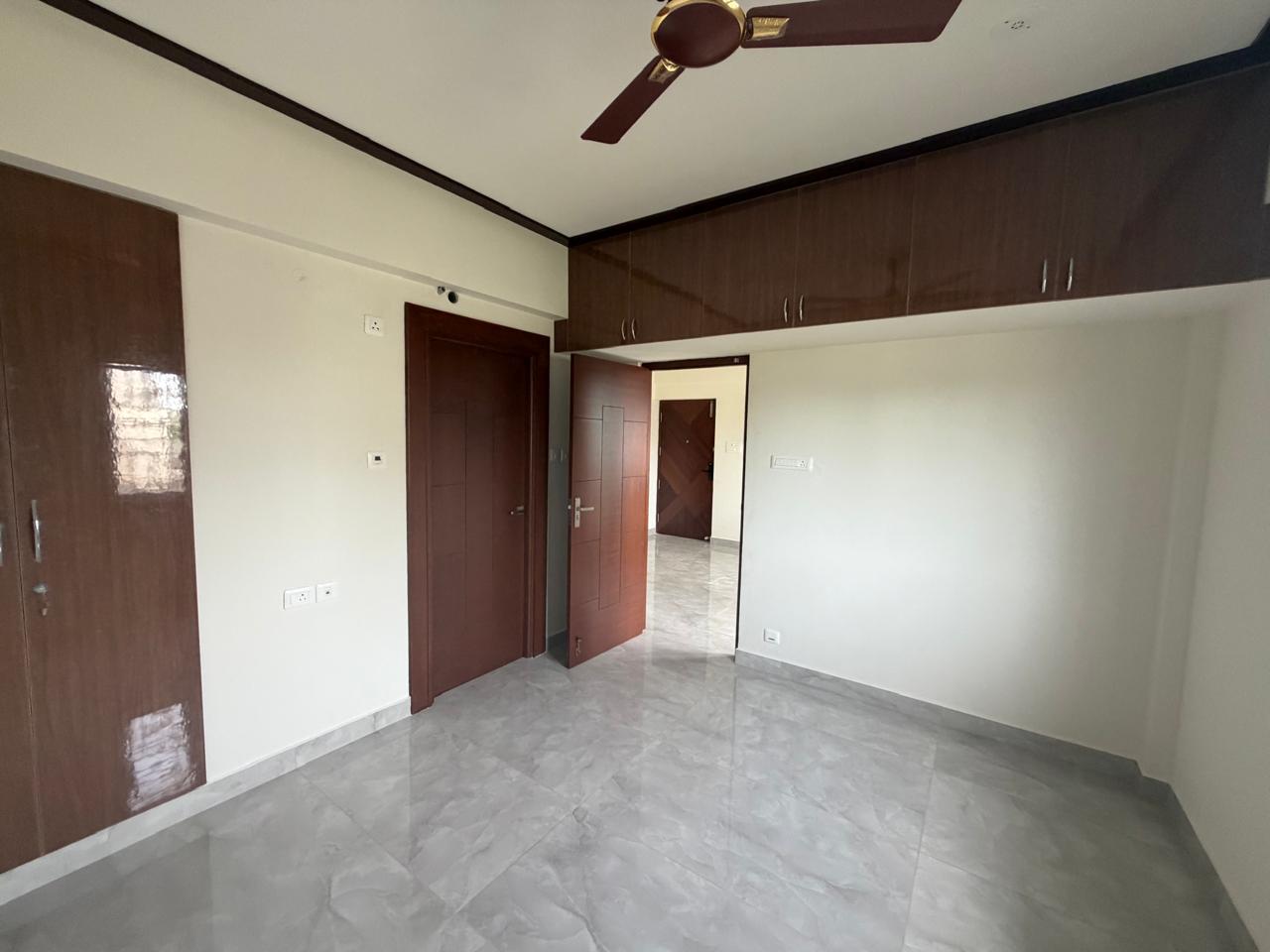

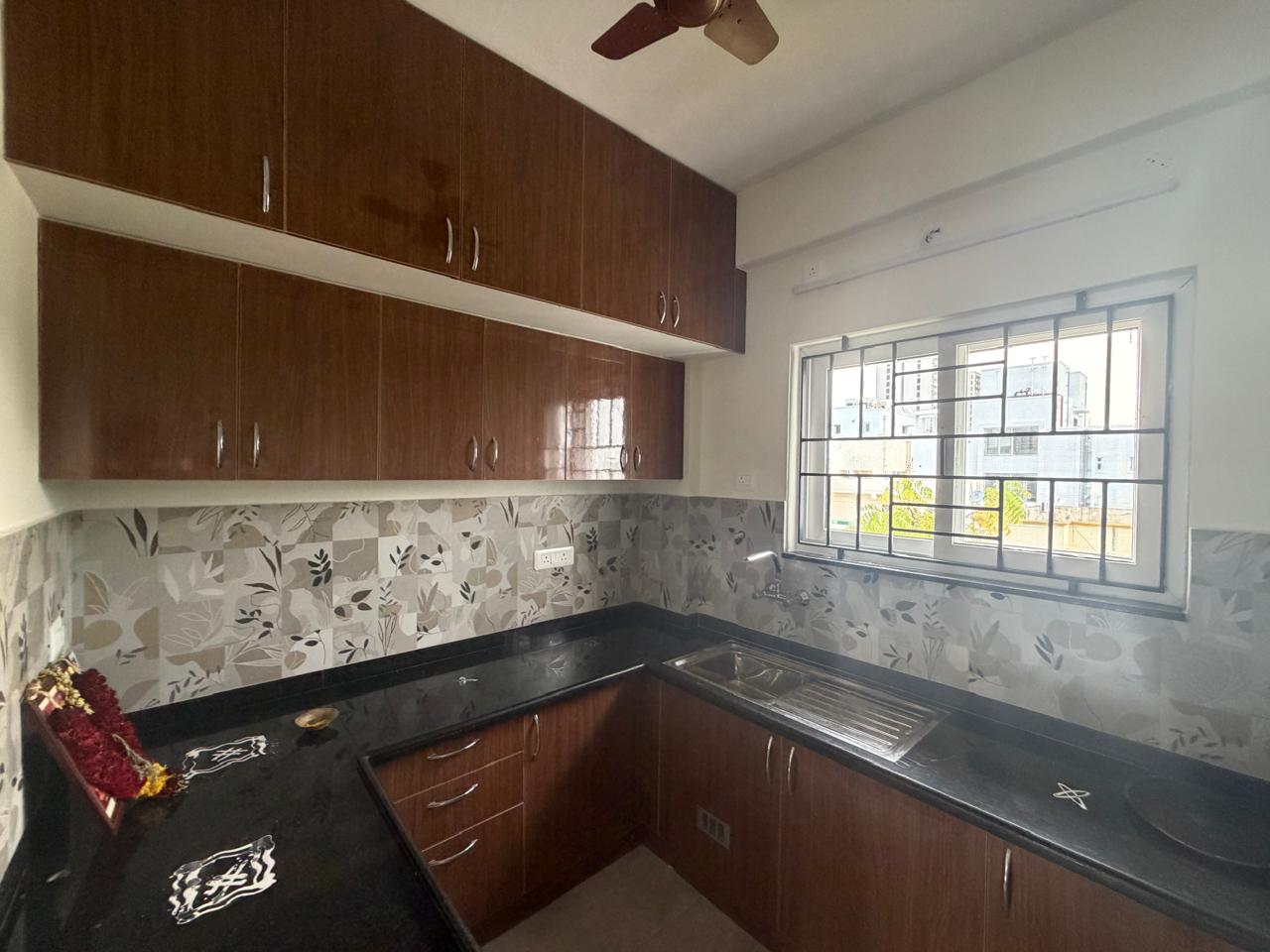

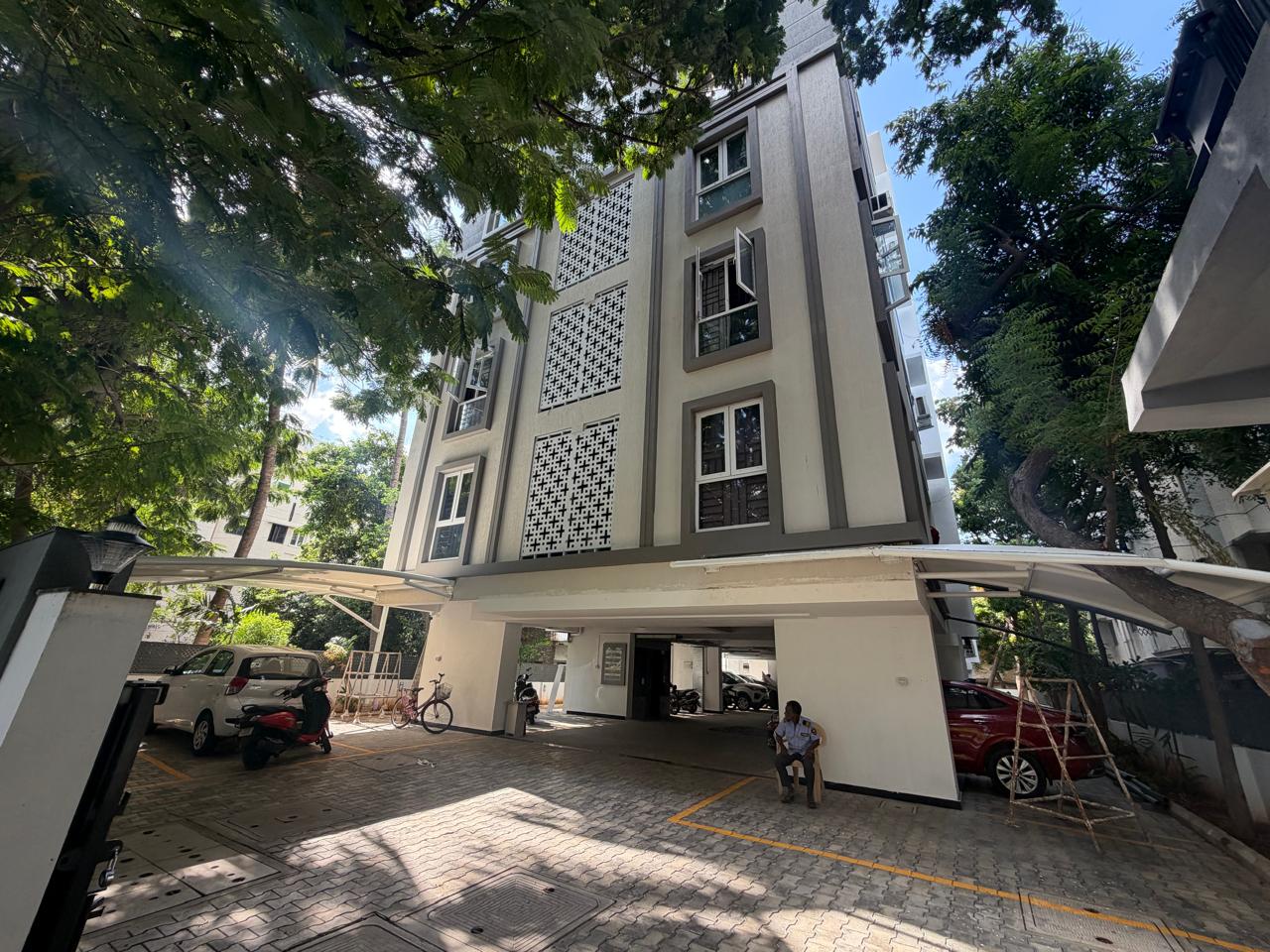

Project Update Images

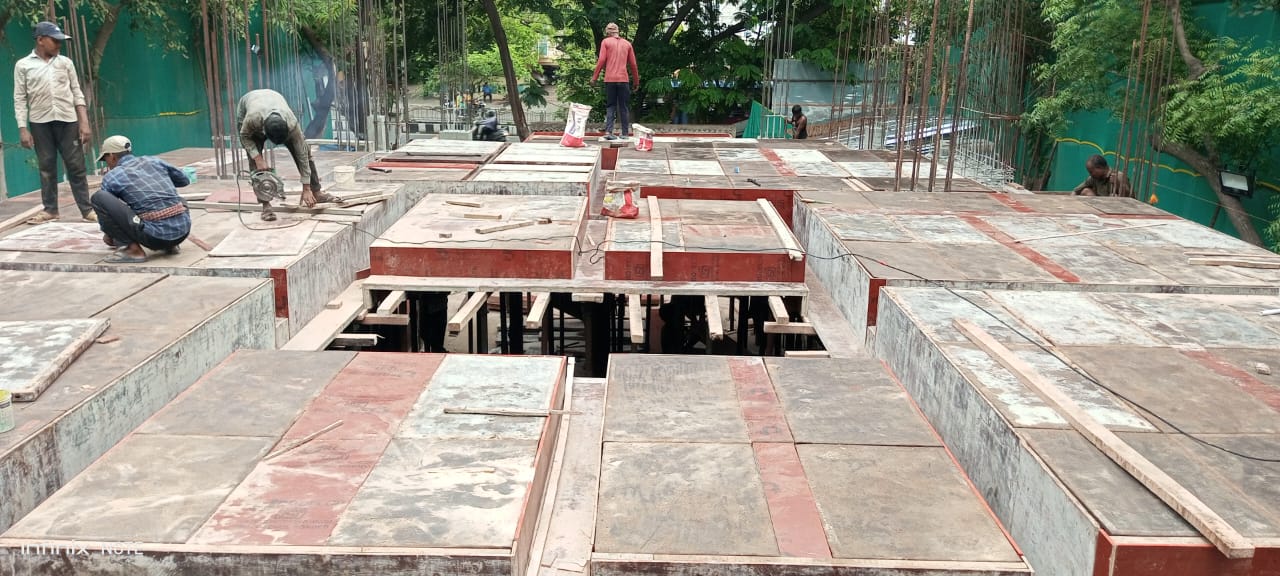

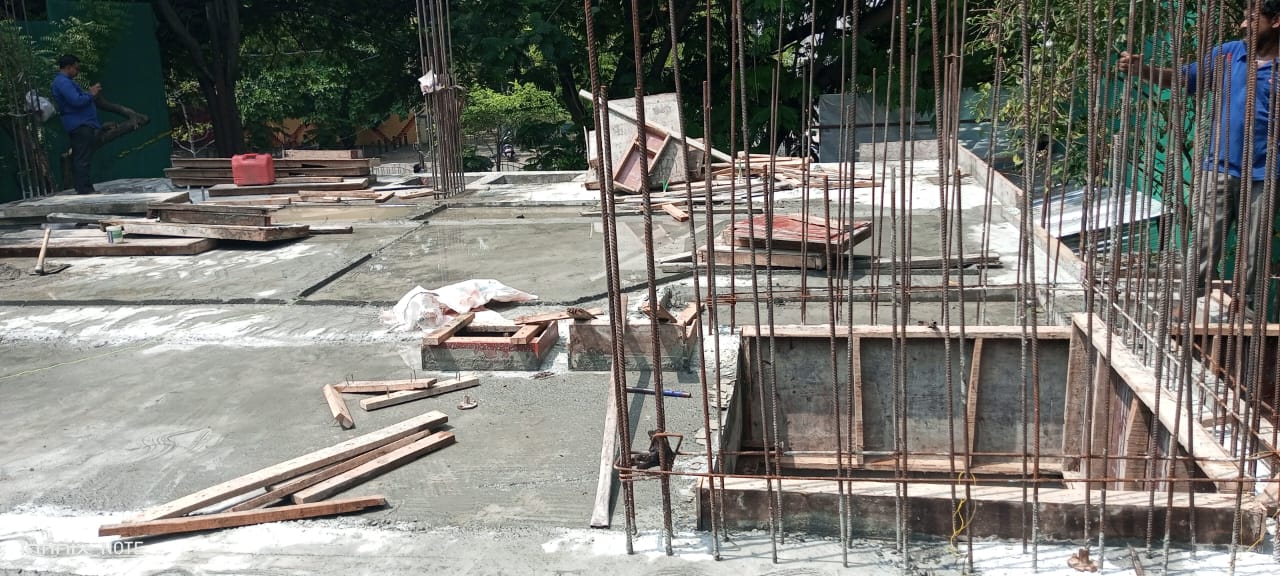

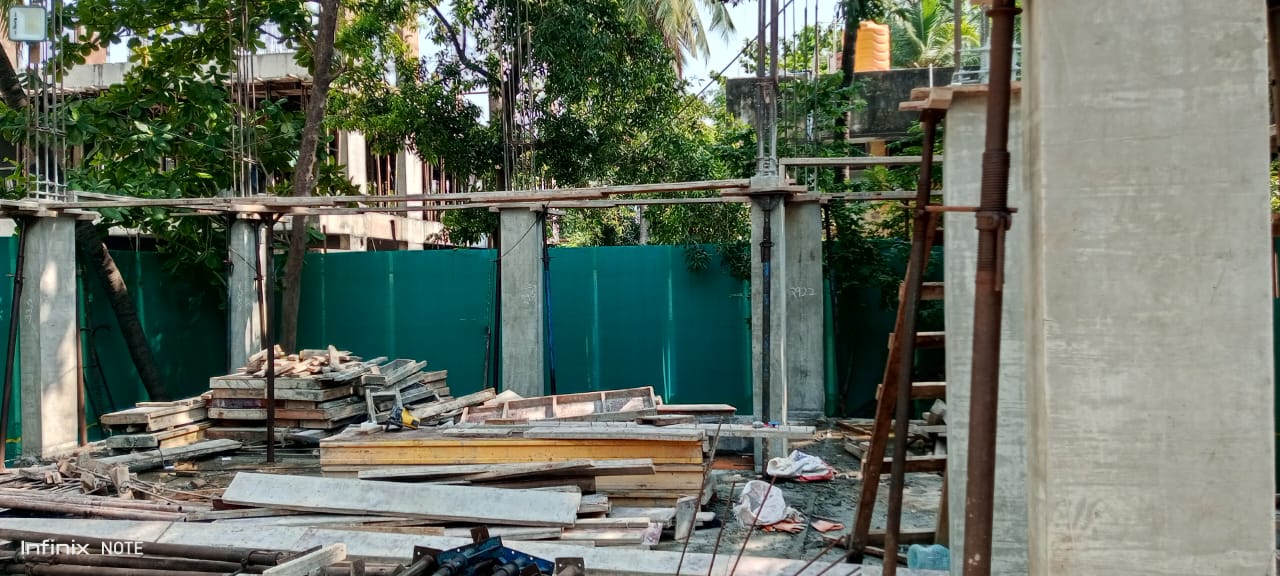

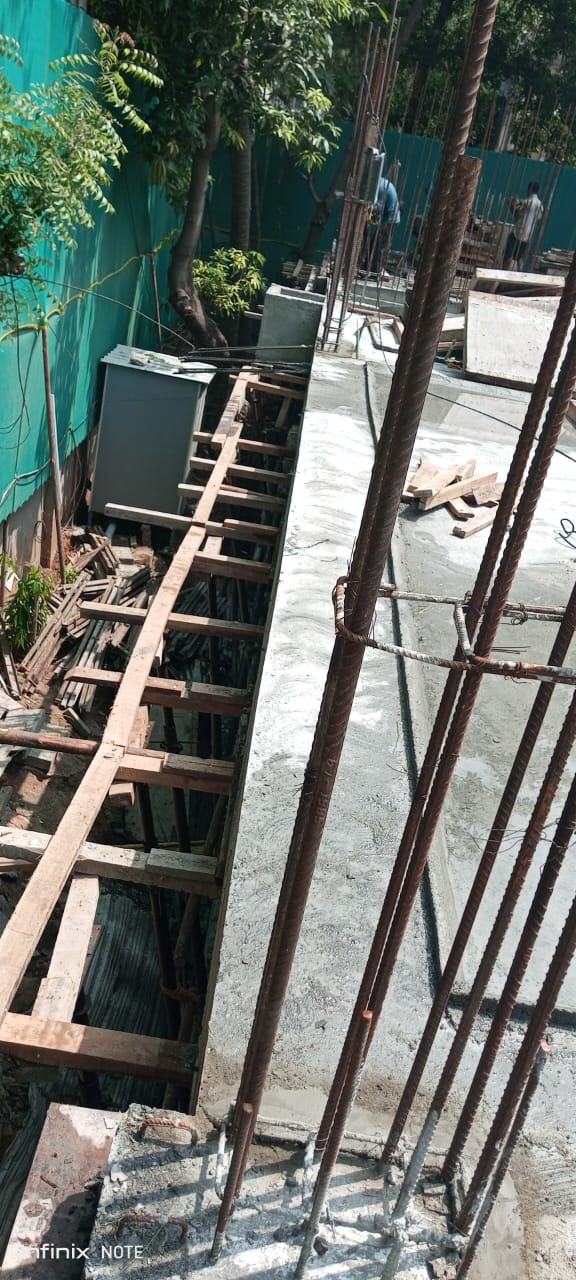

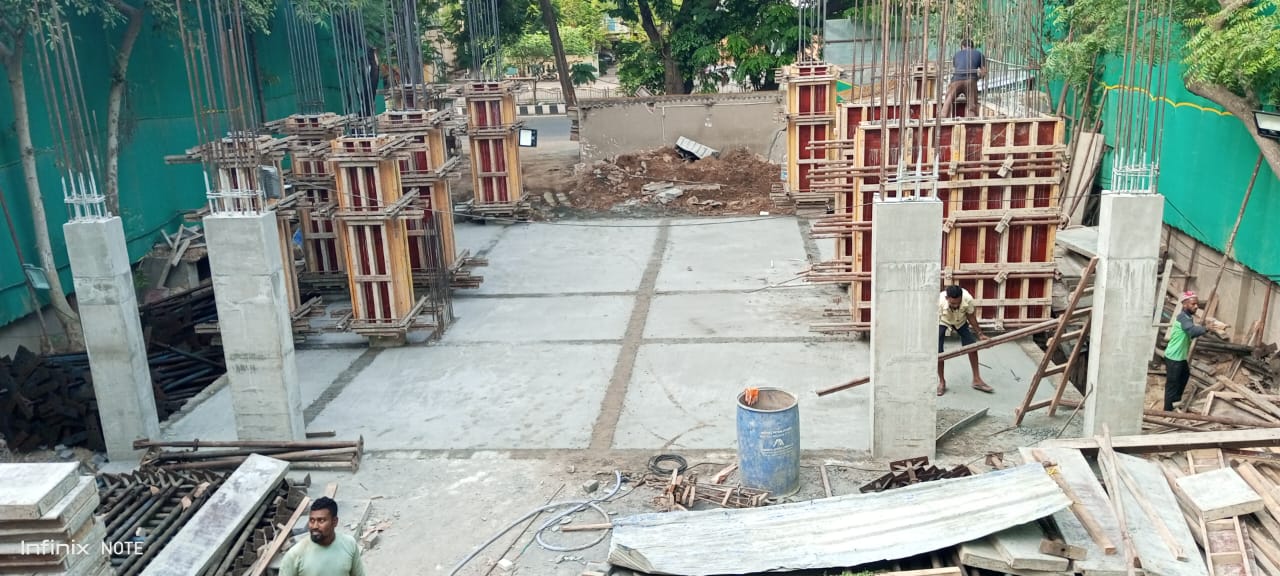

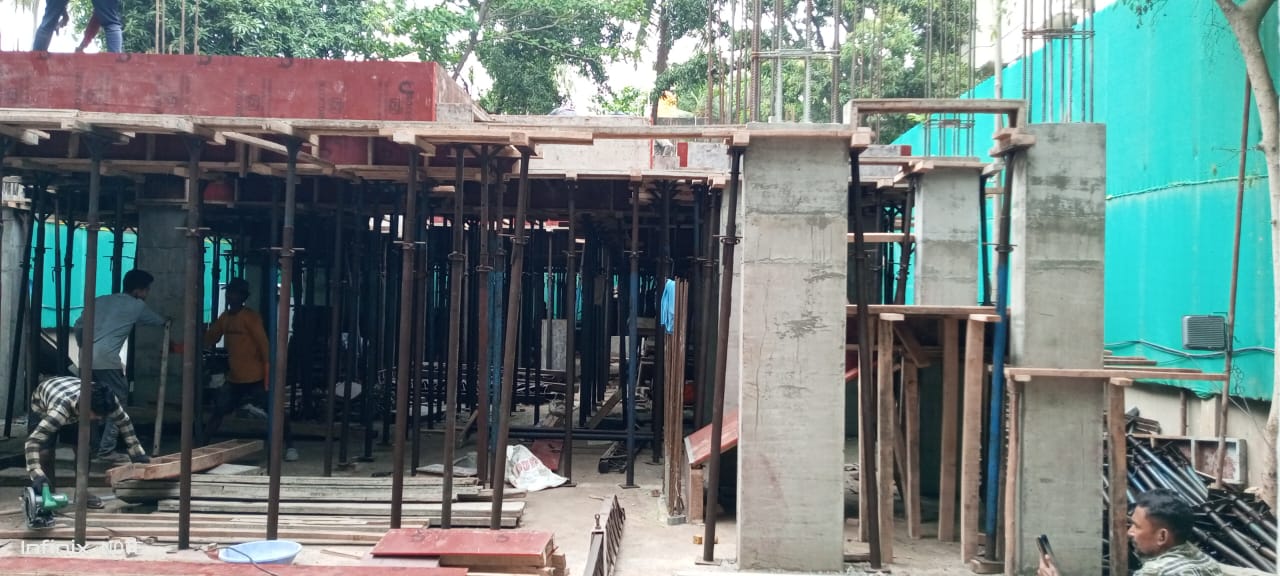

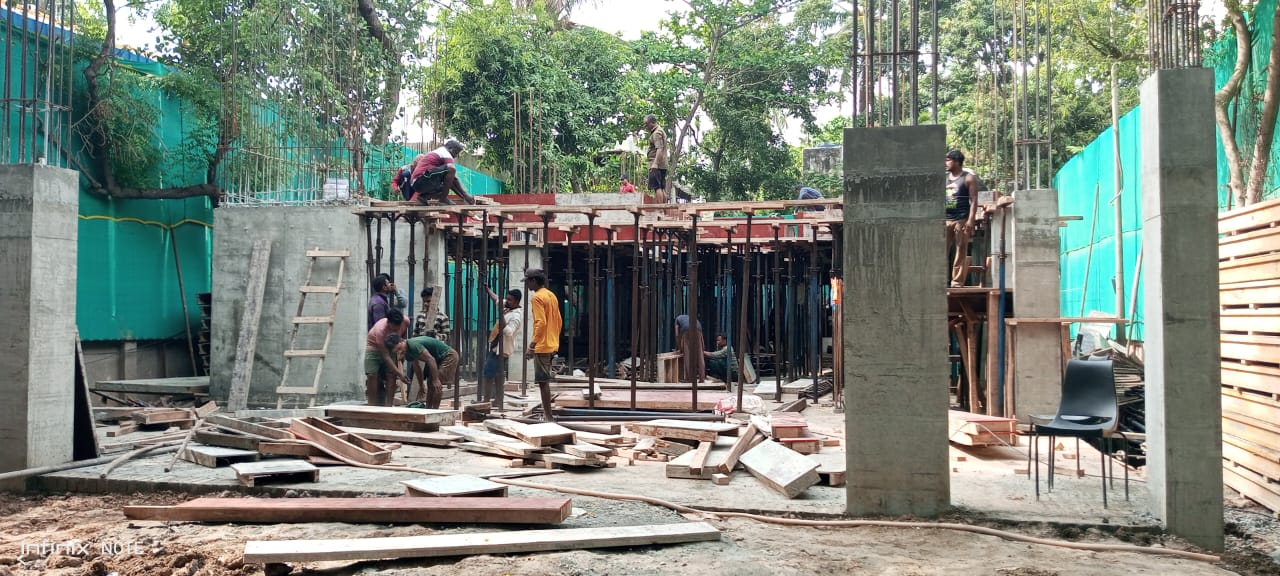

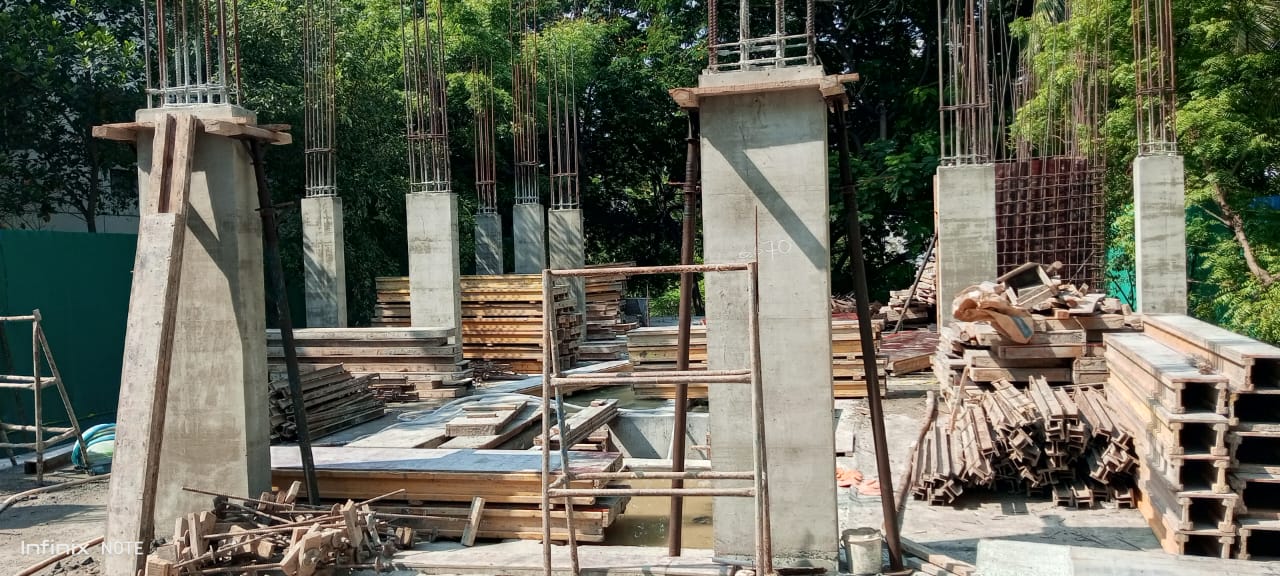

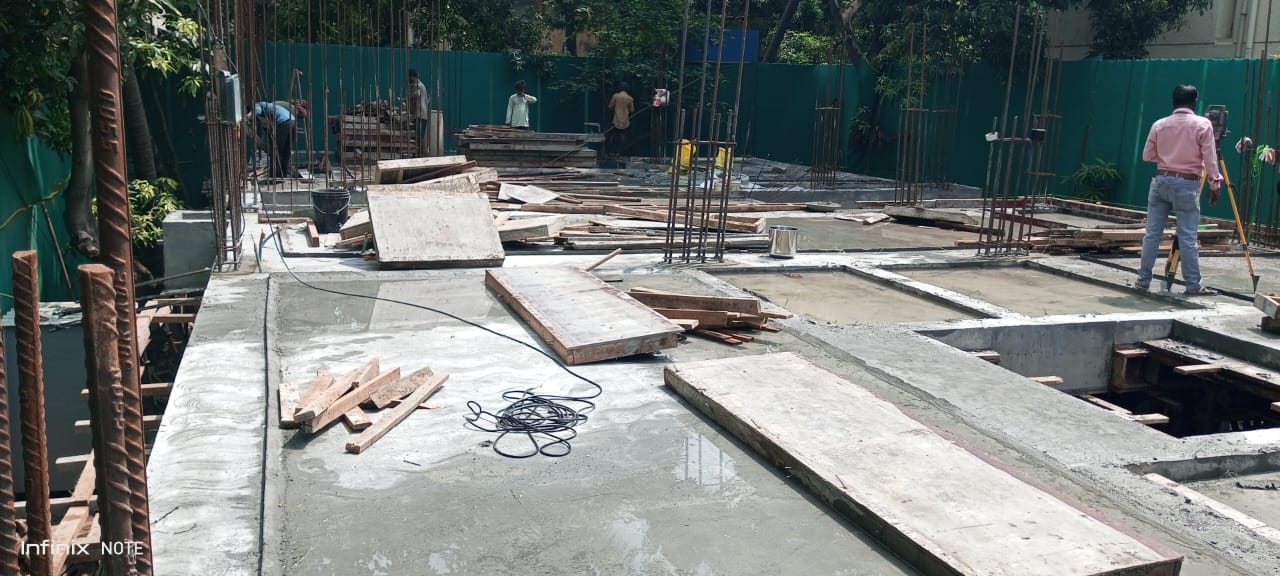

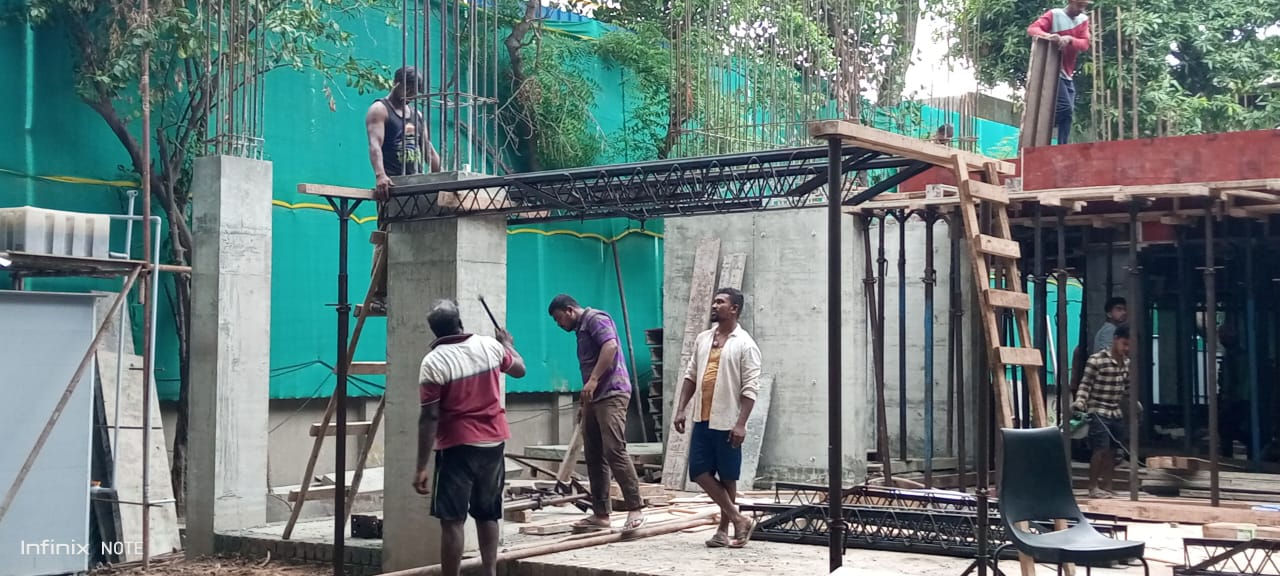

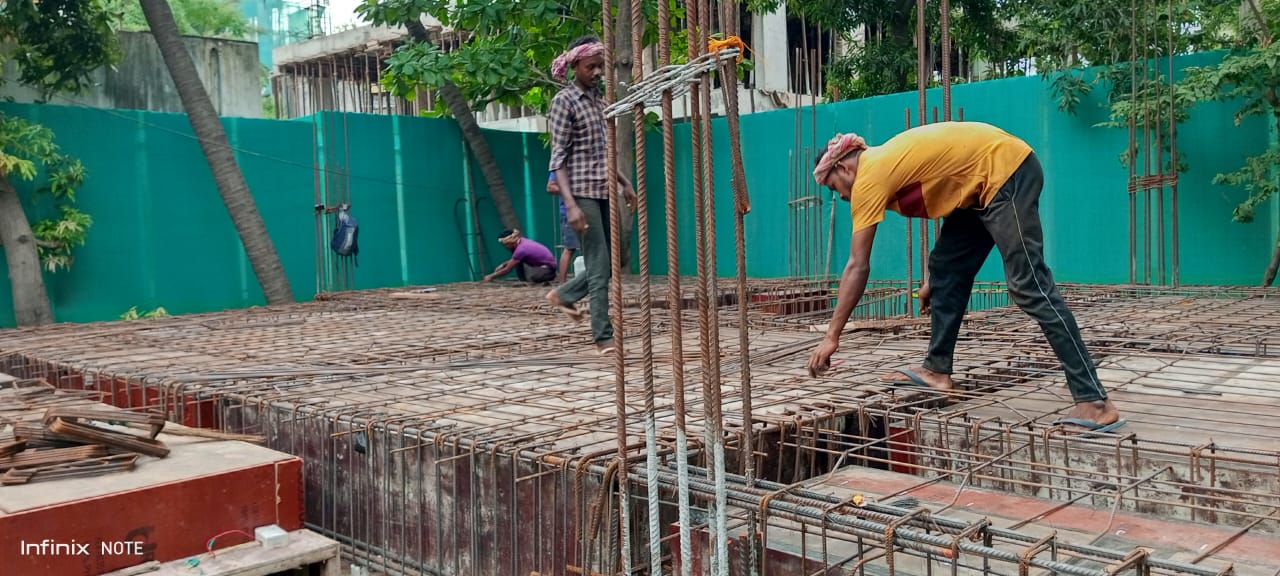

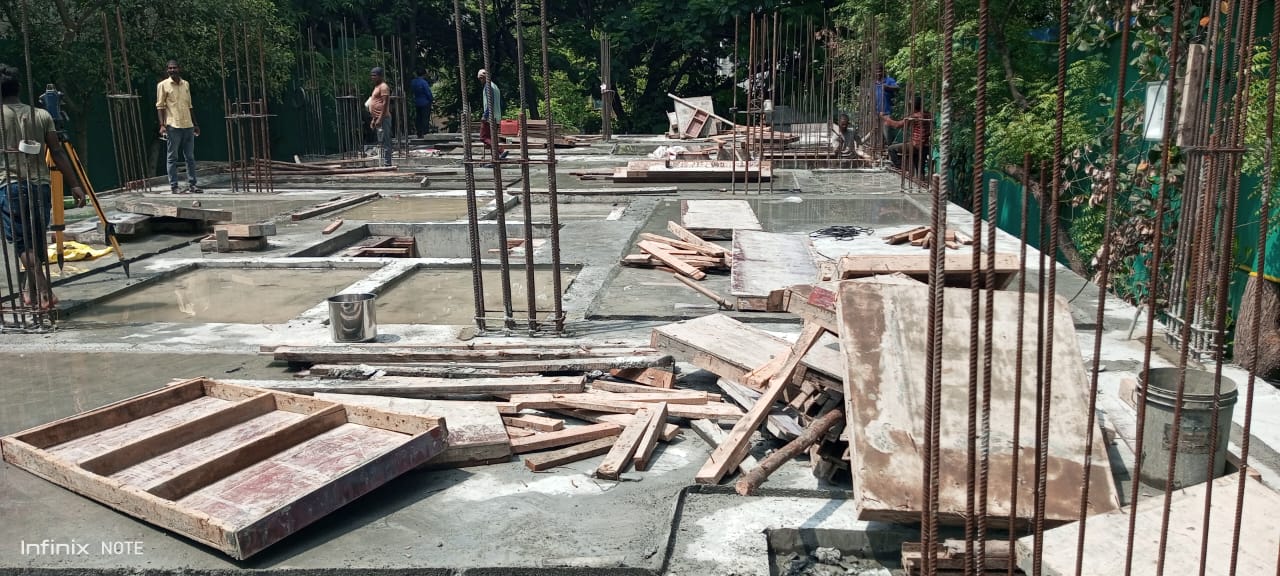

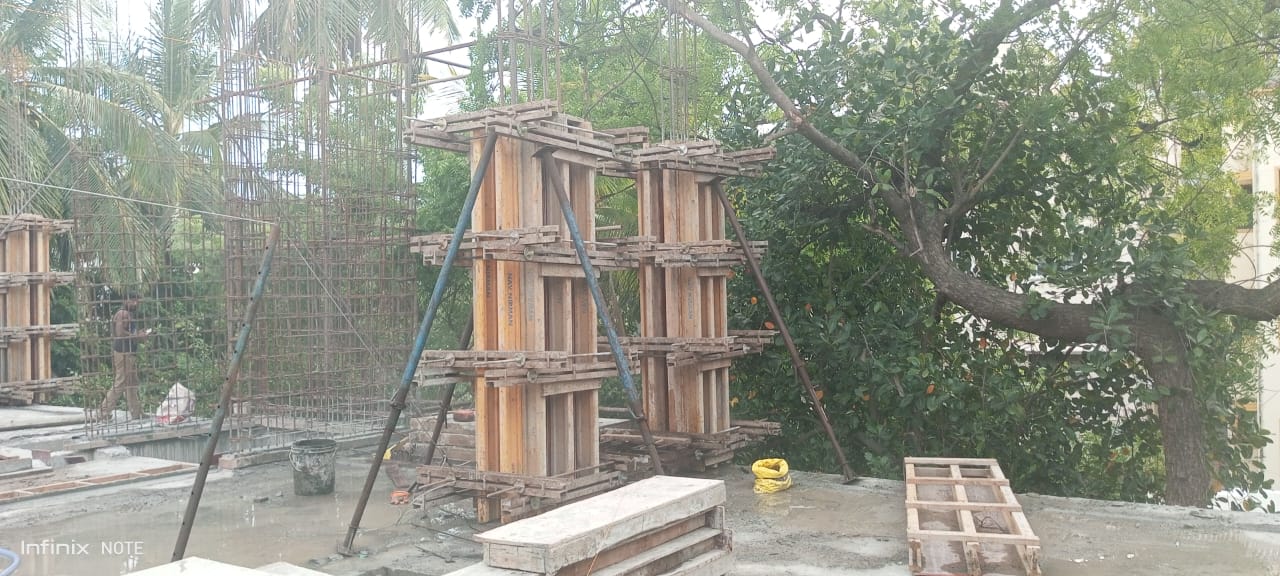

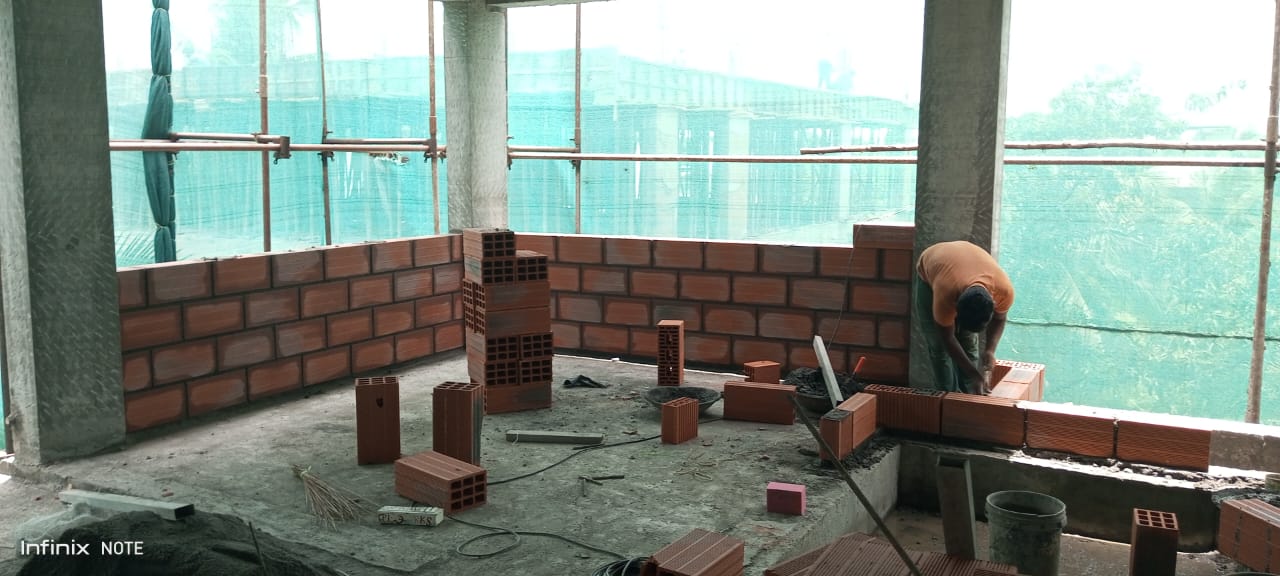

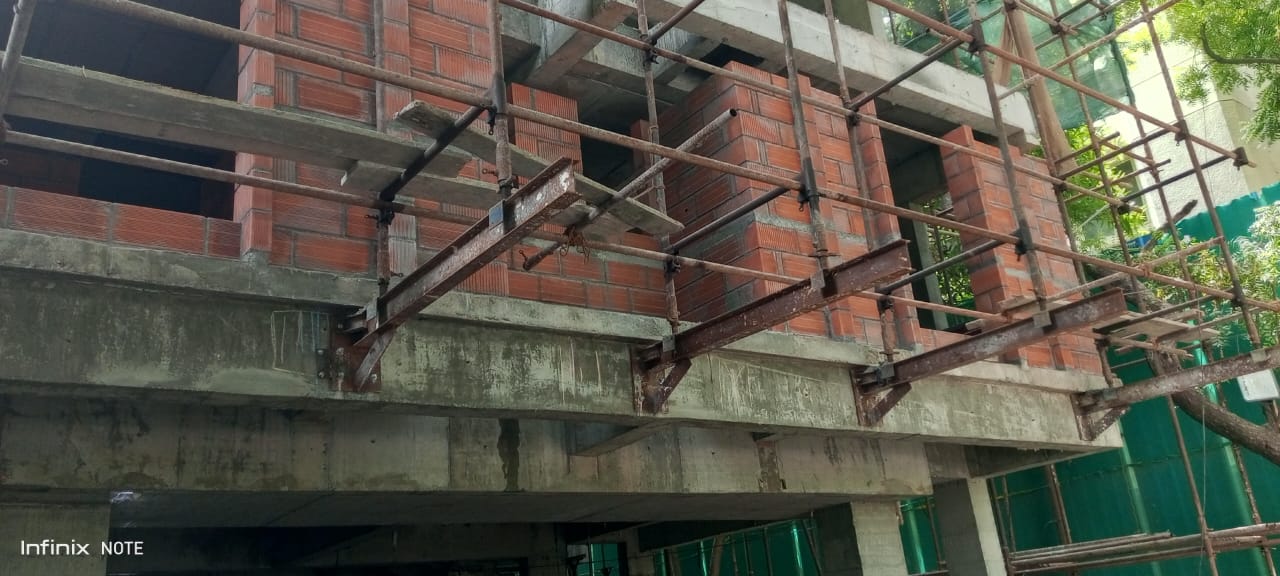

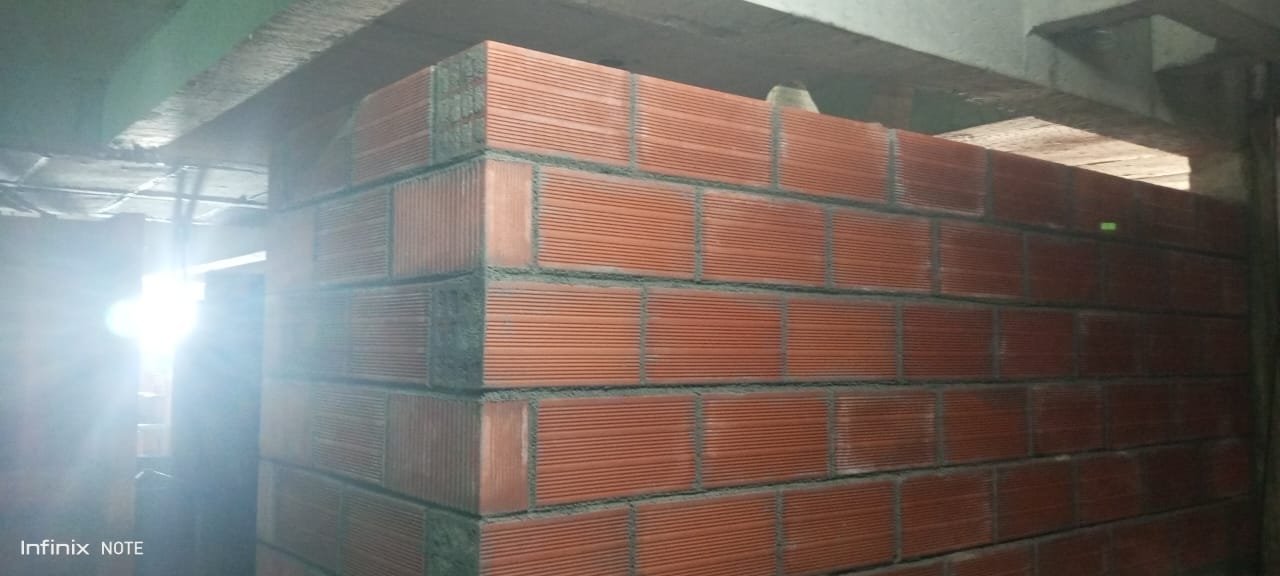

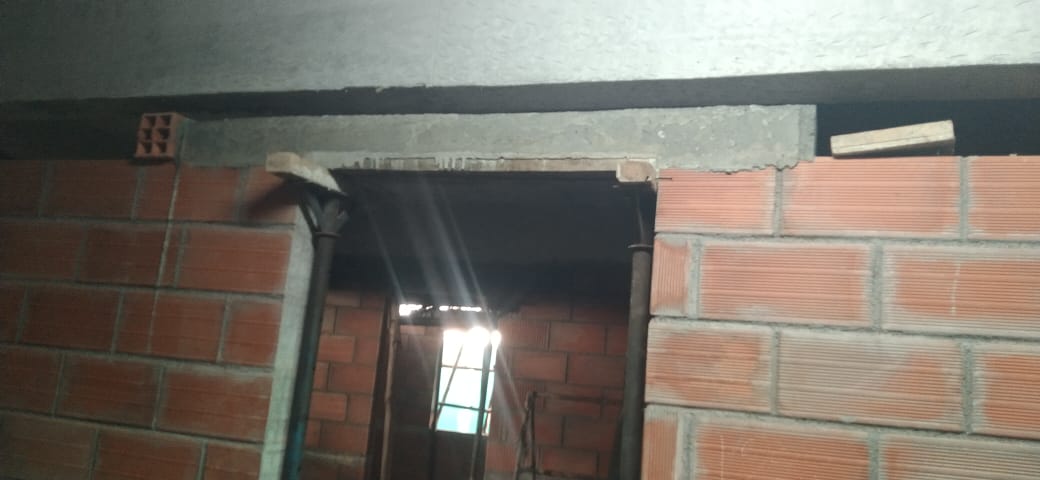

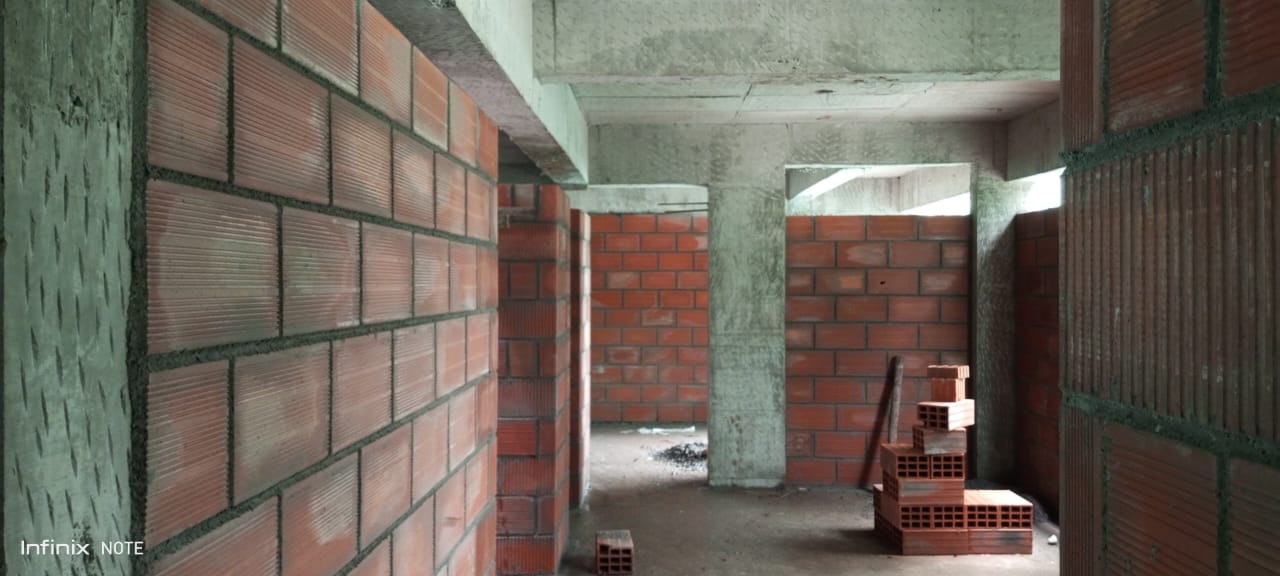

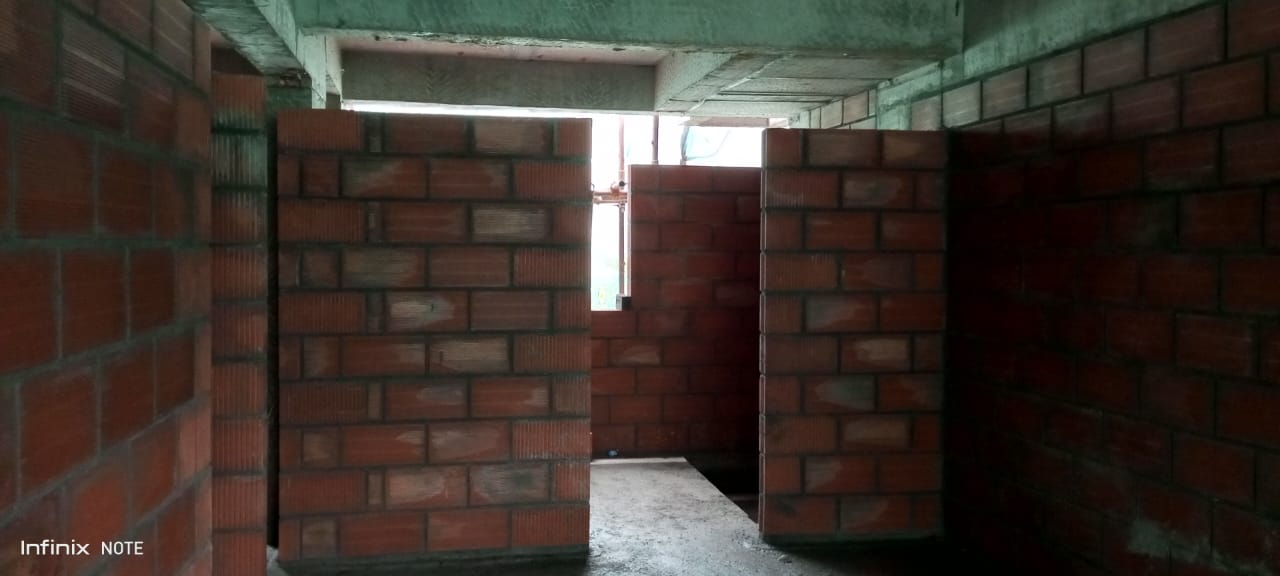

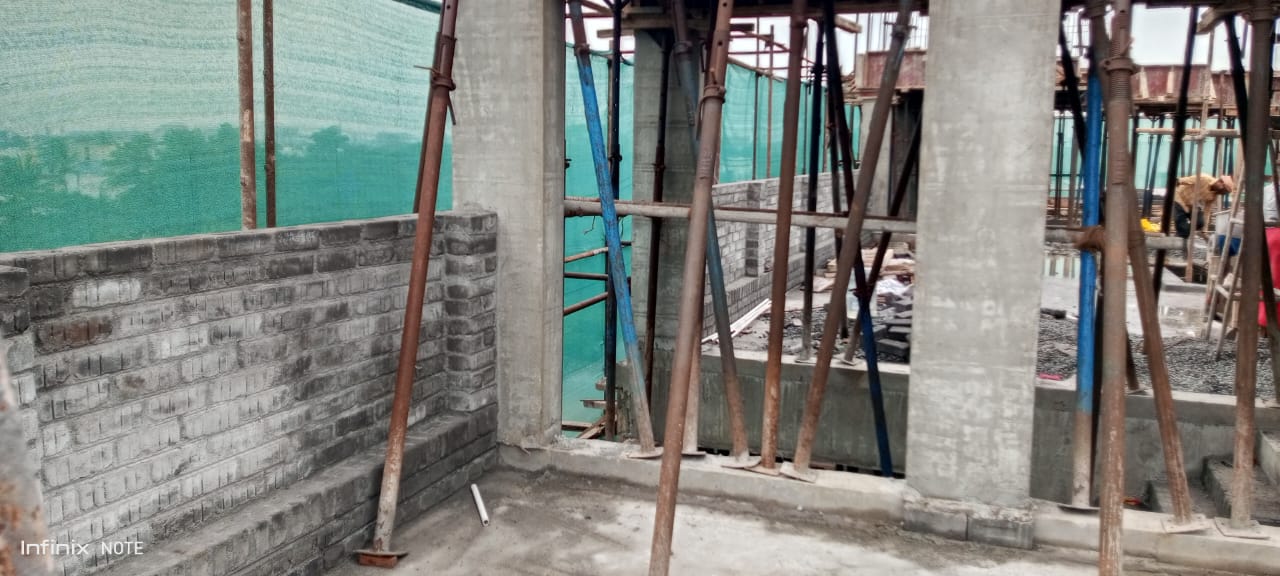

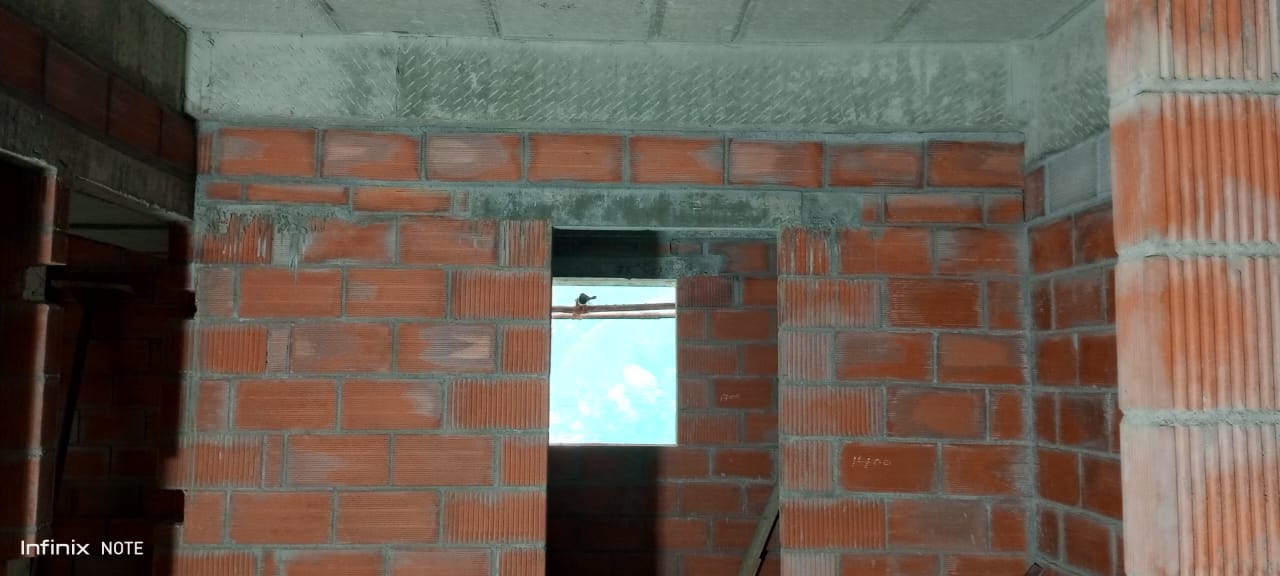

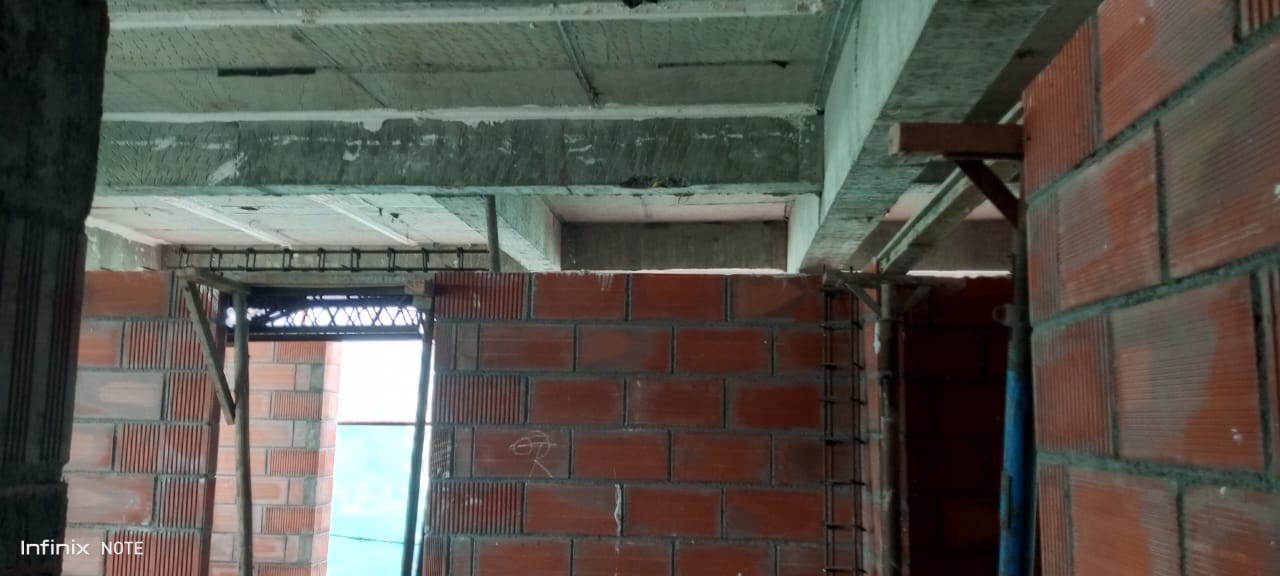

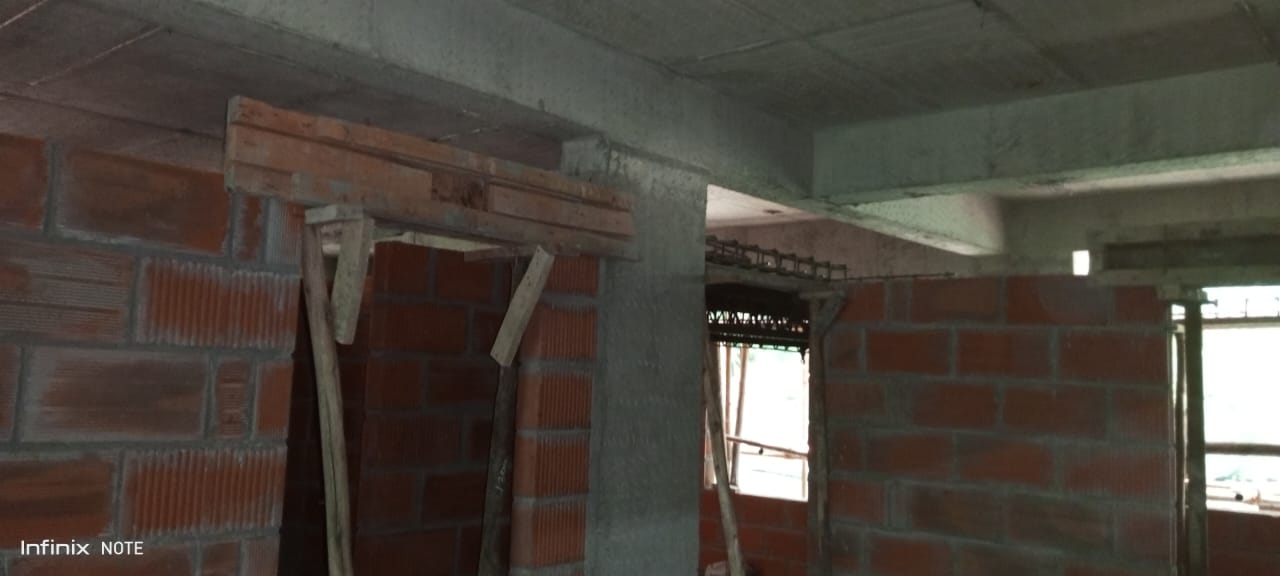

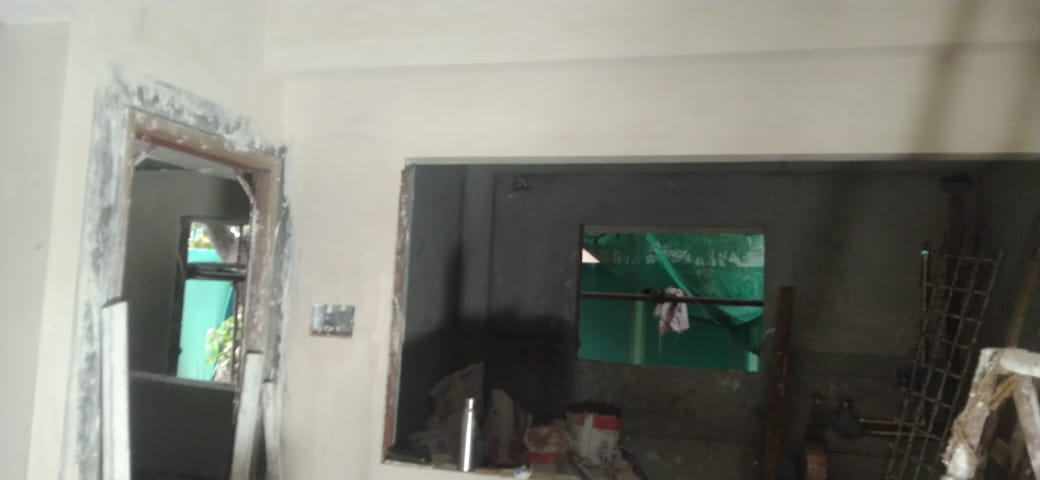

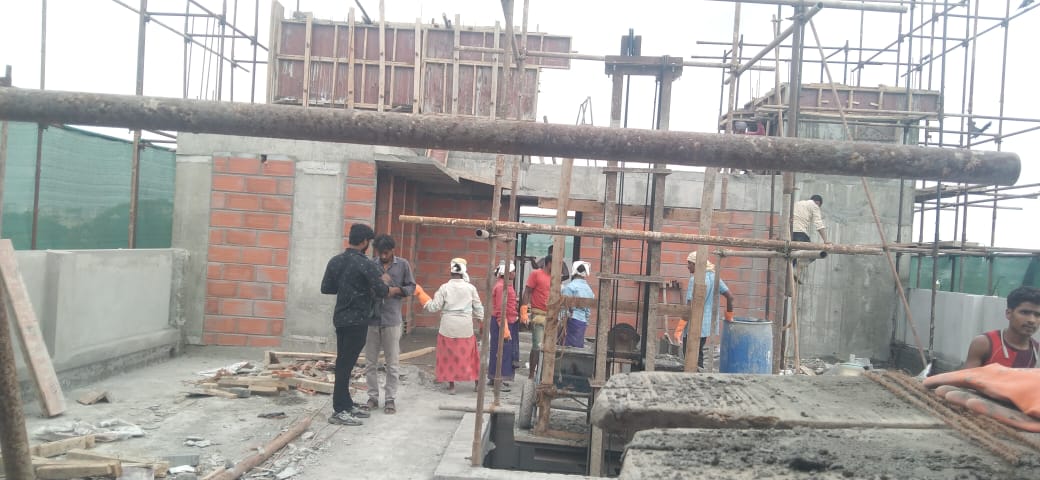

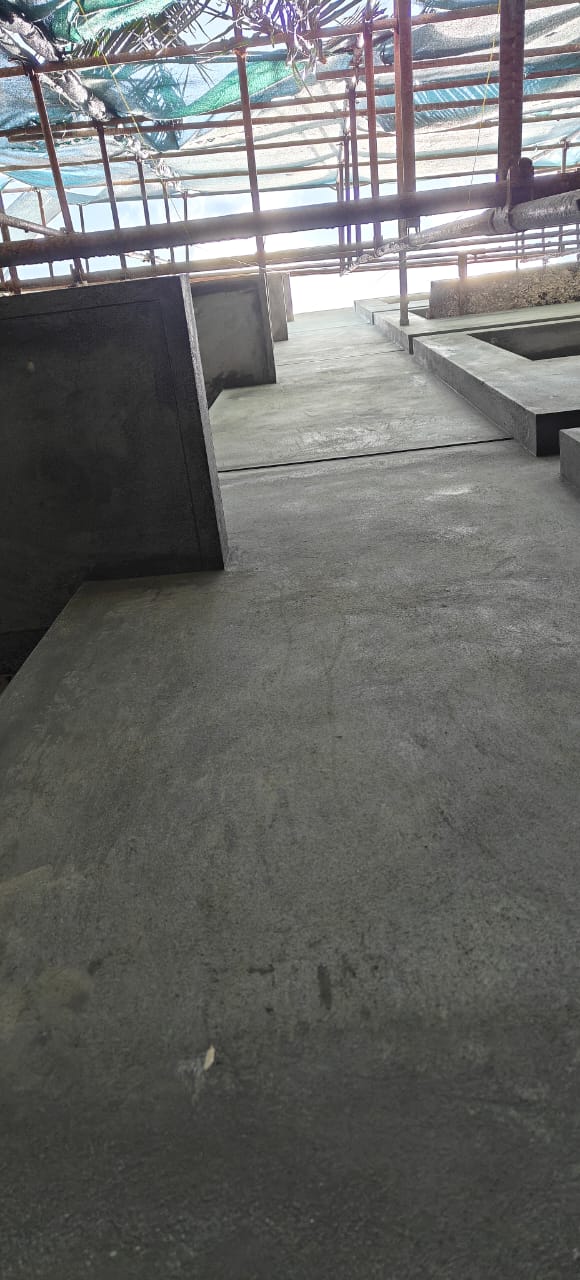

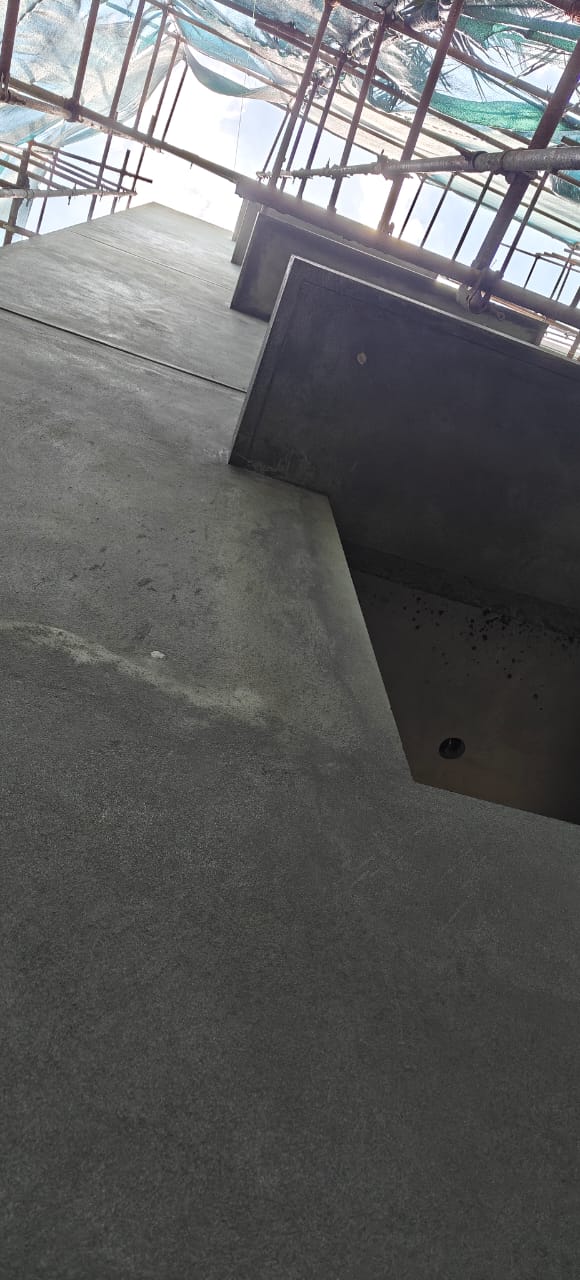

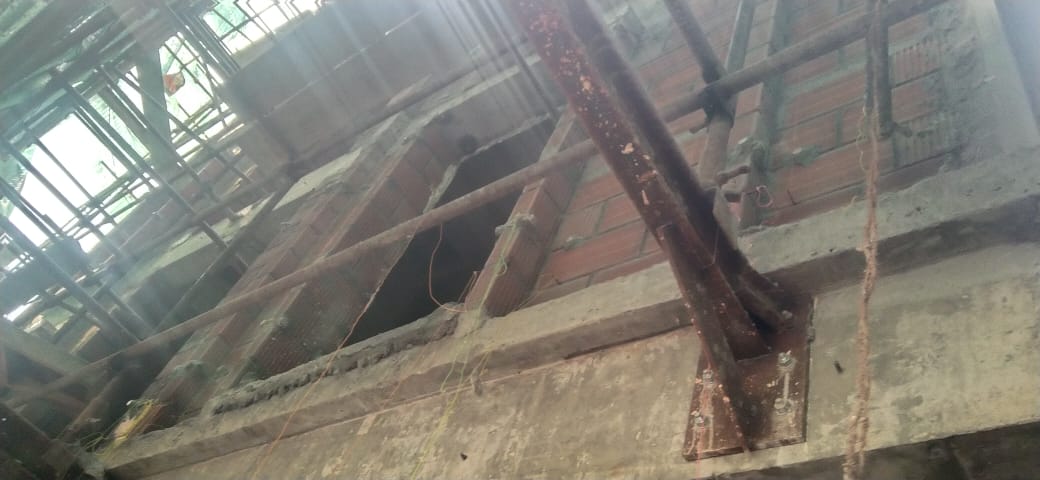

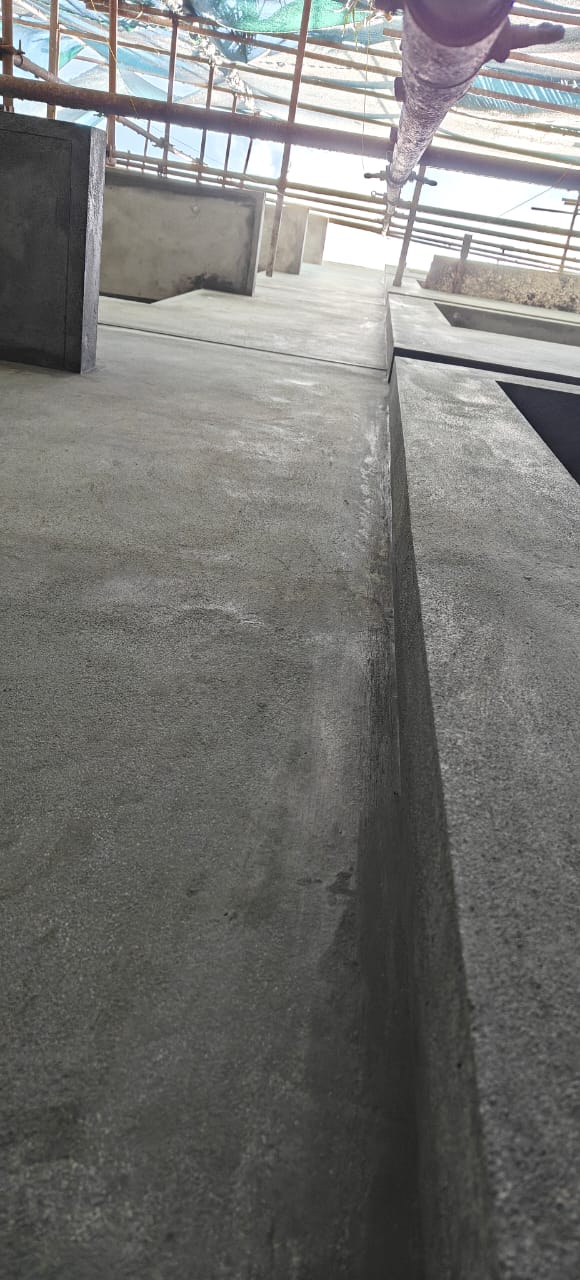

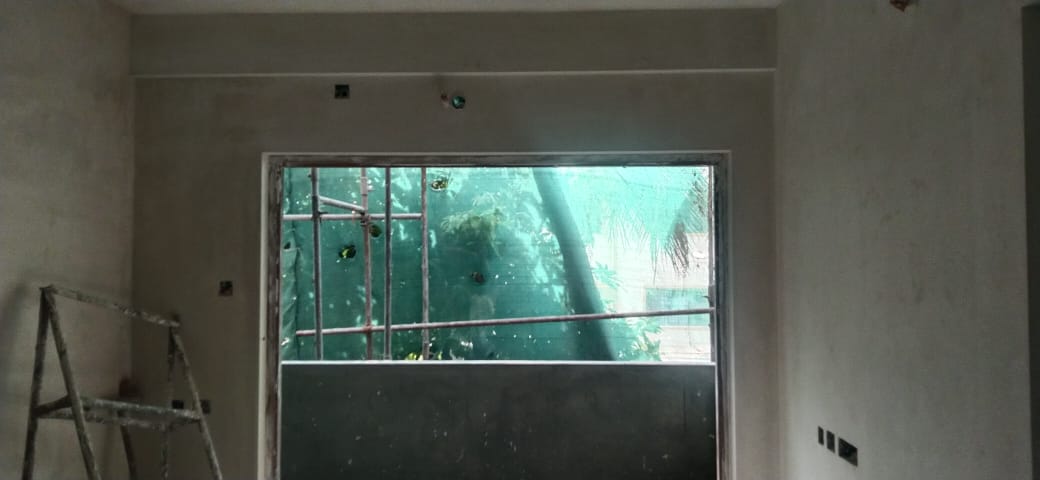

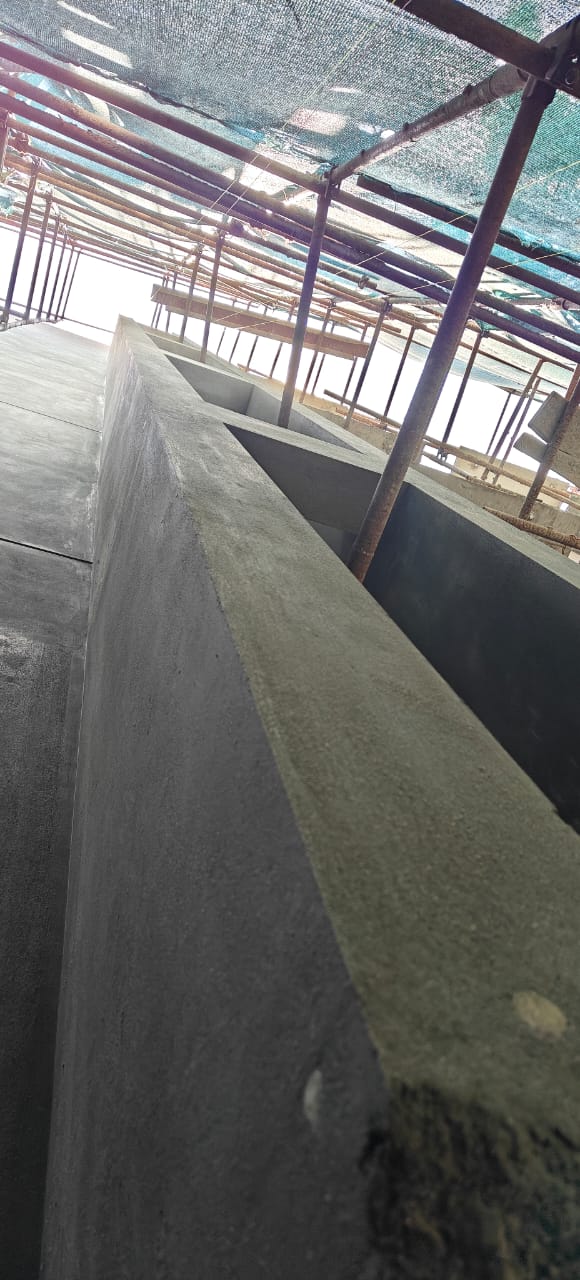

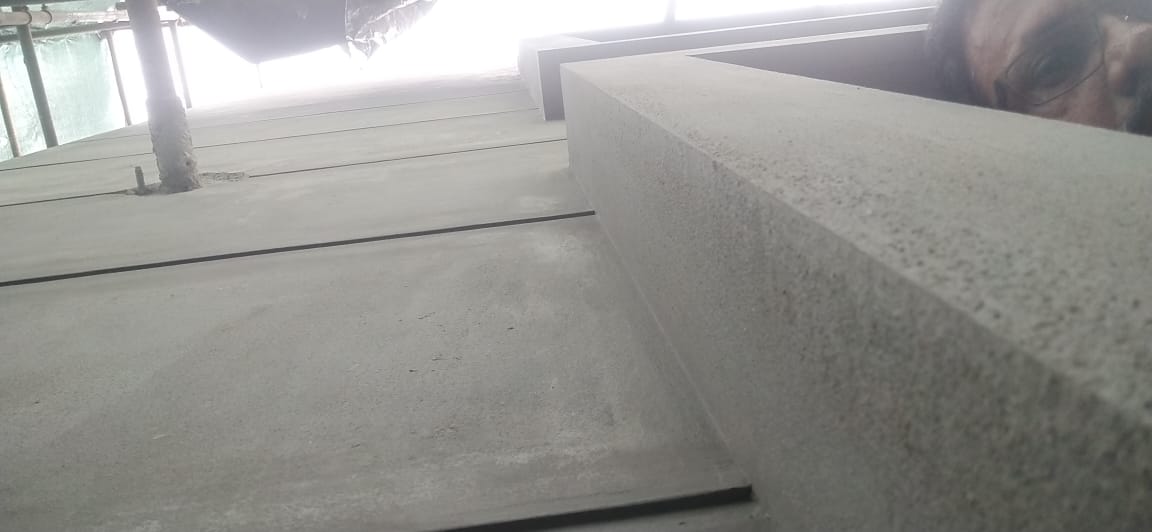

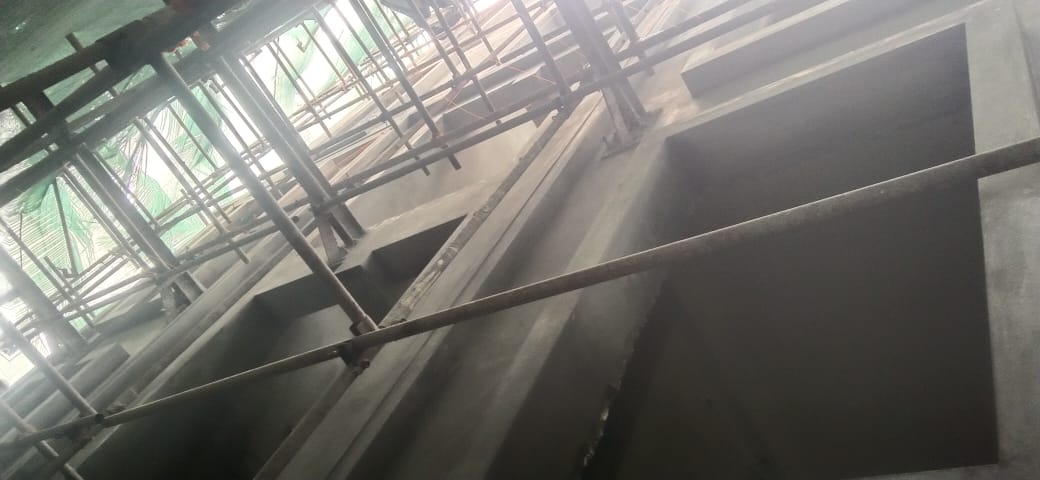

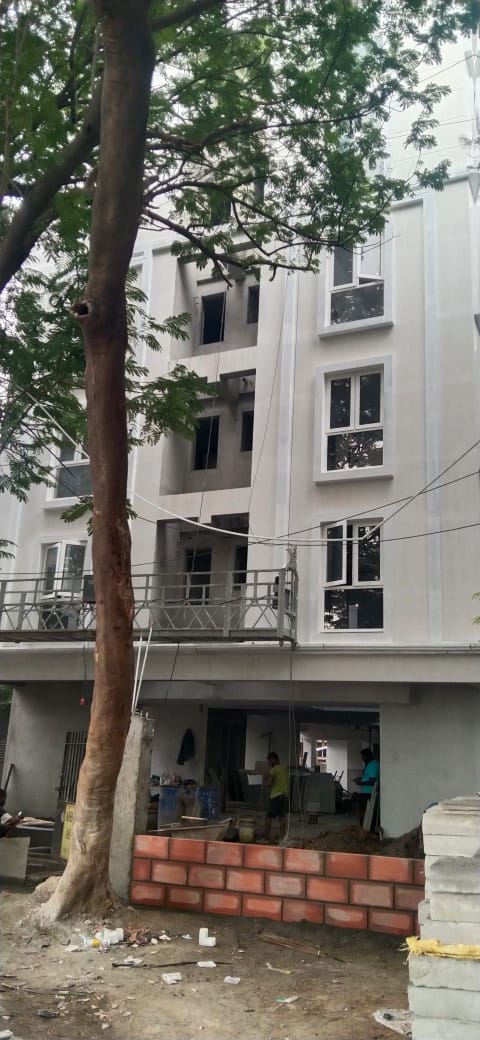

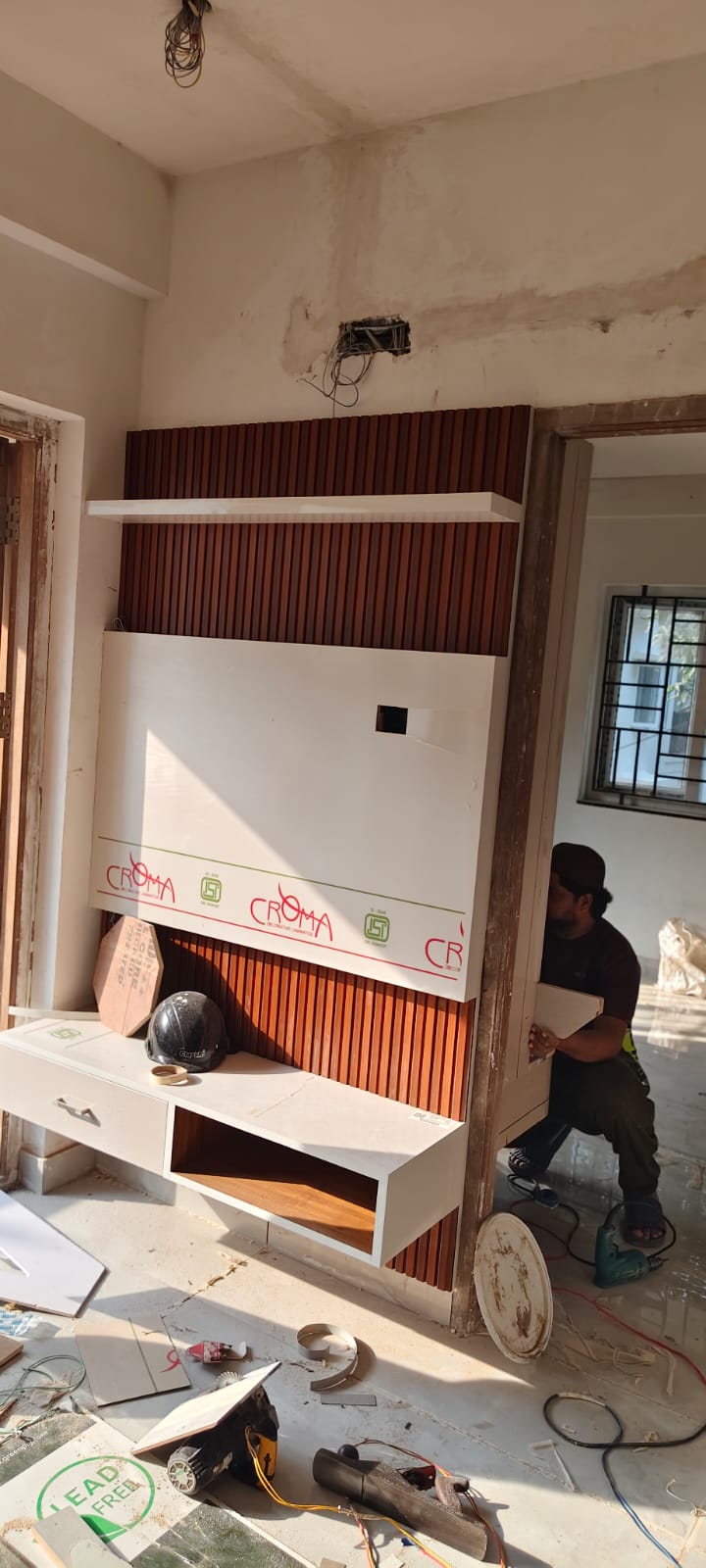

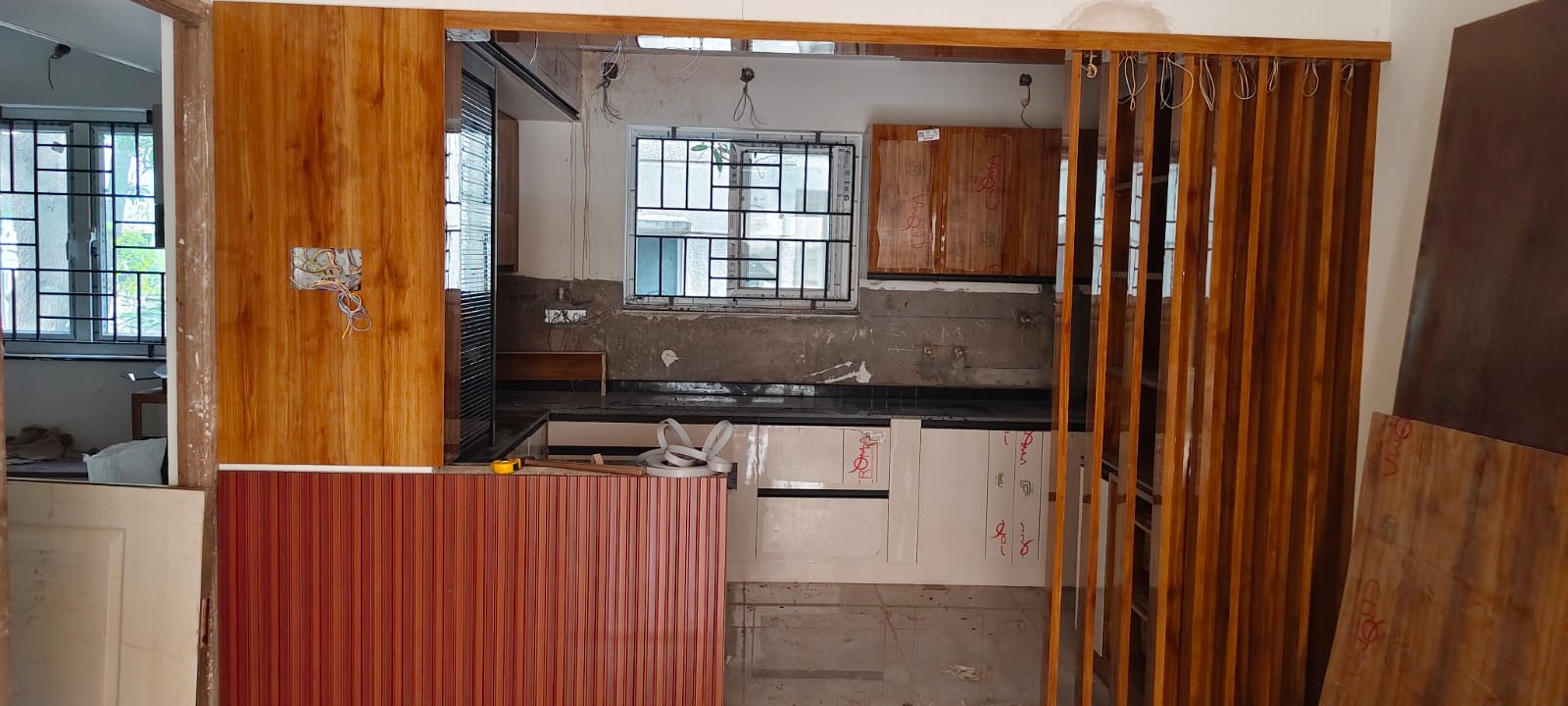

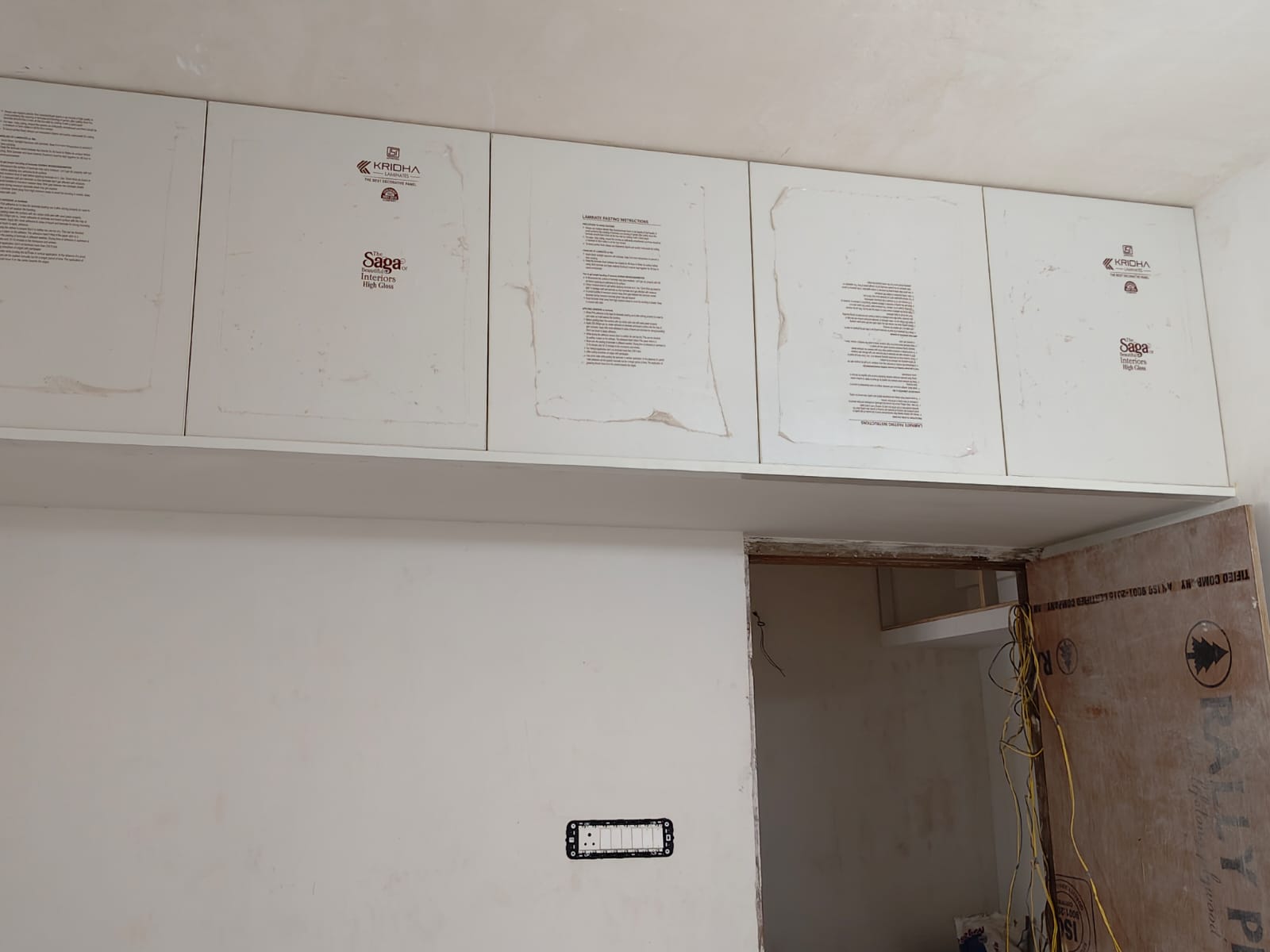

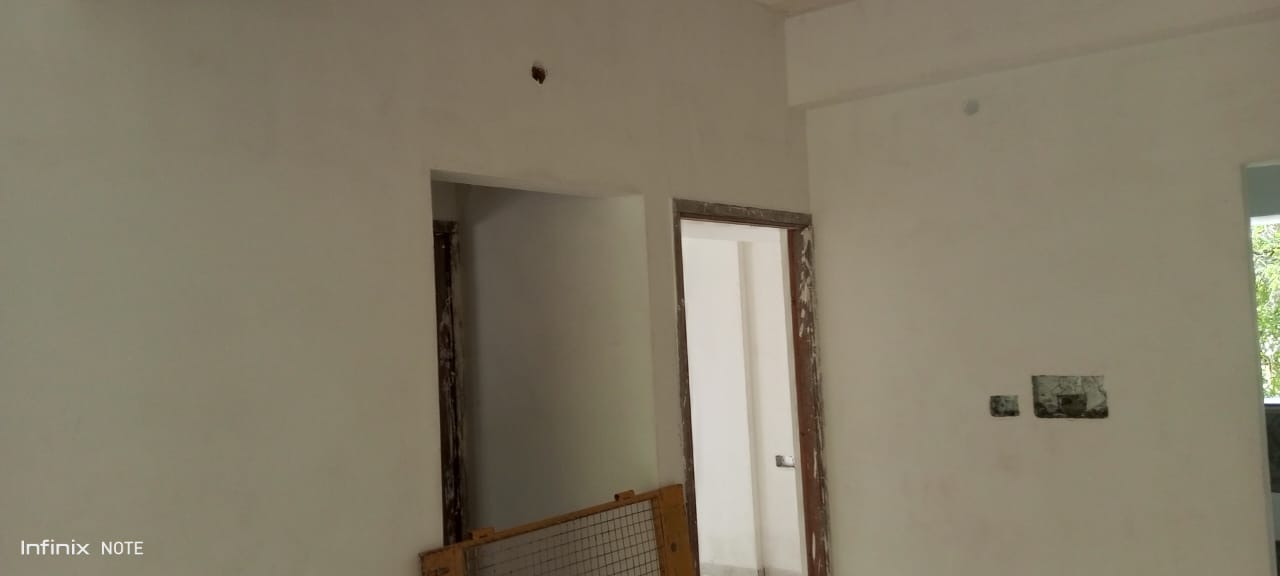

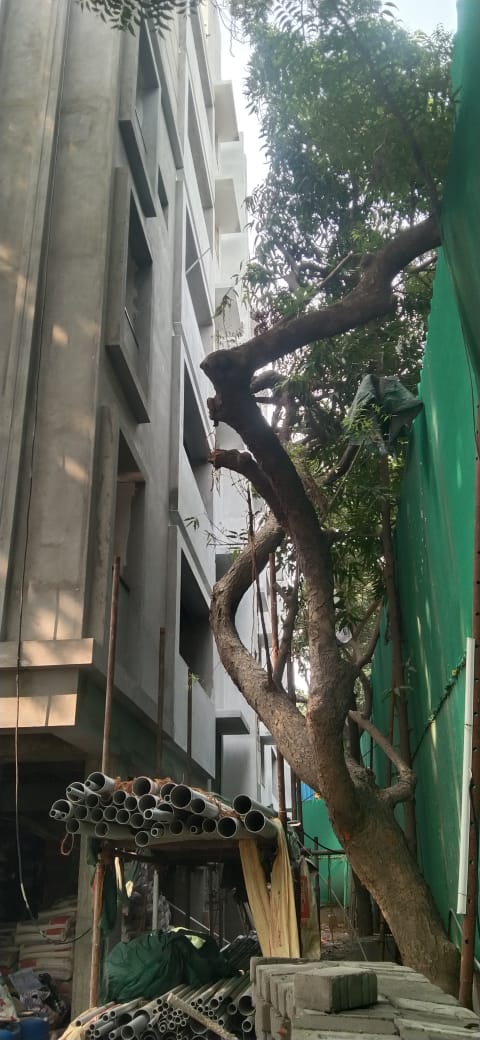

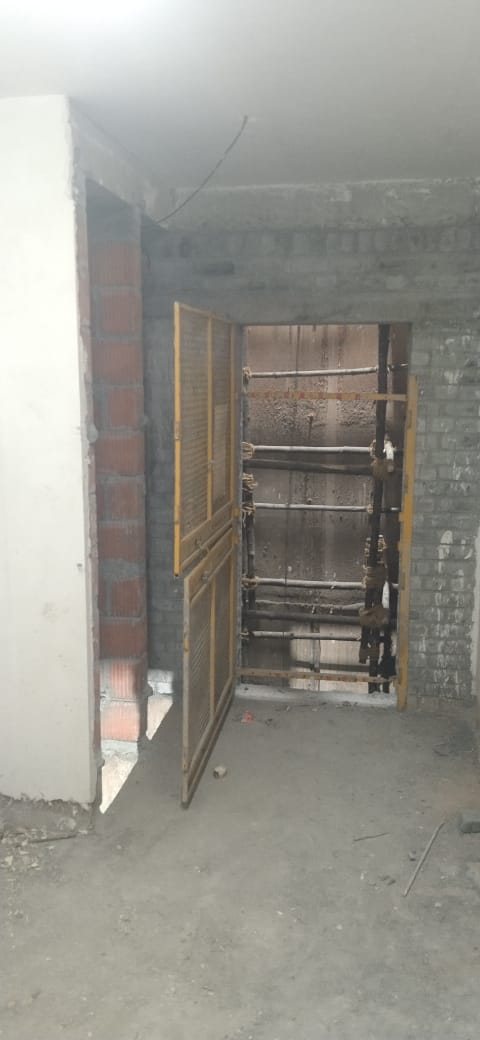

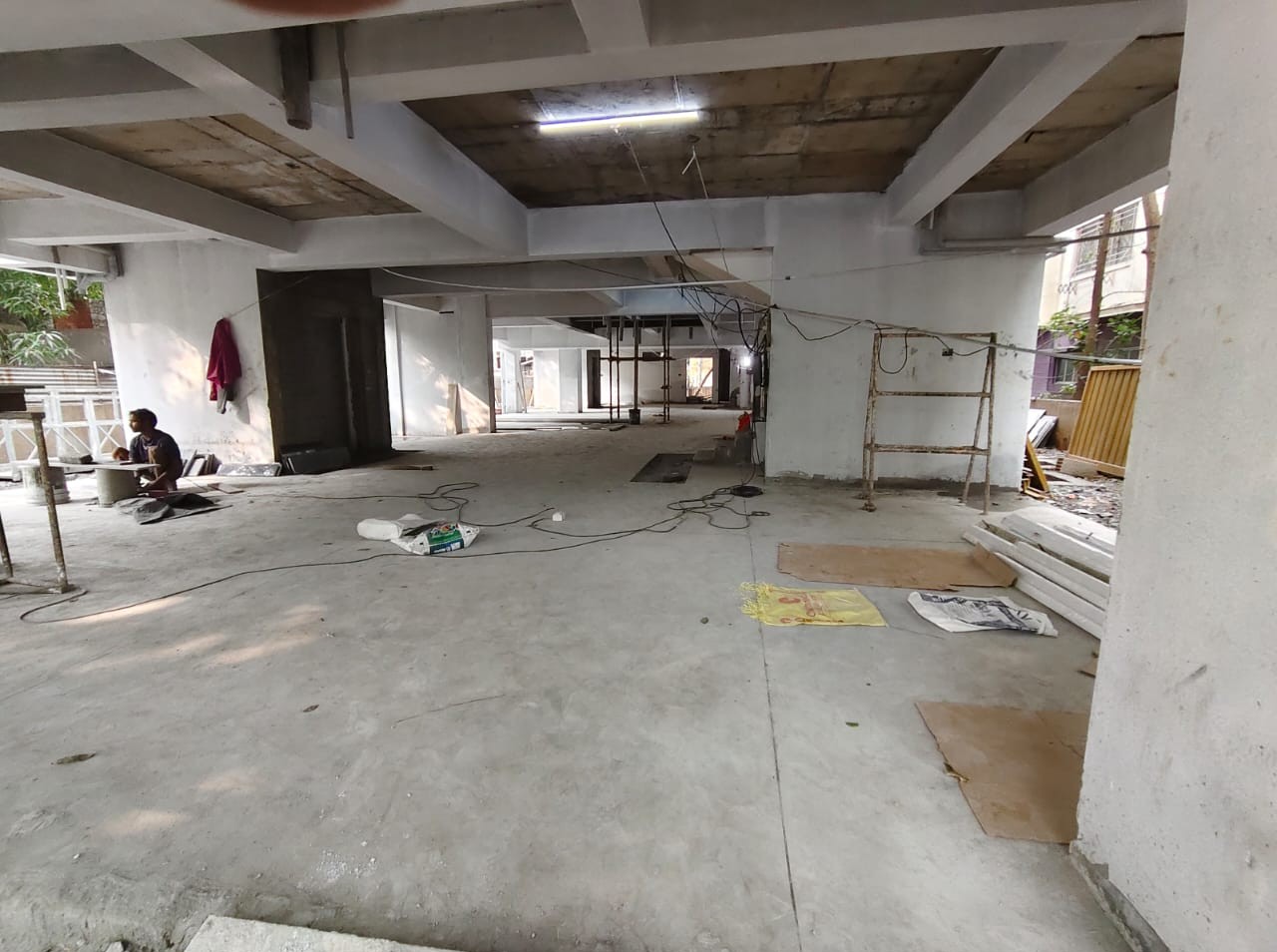

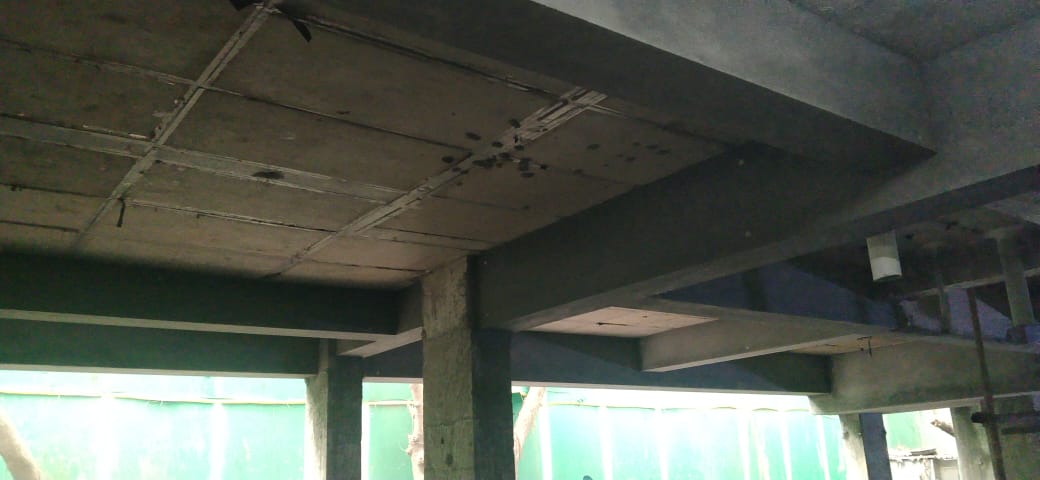

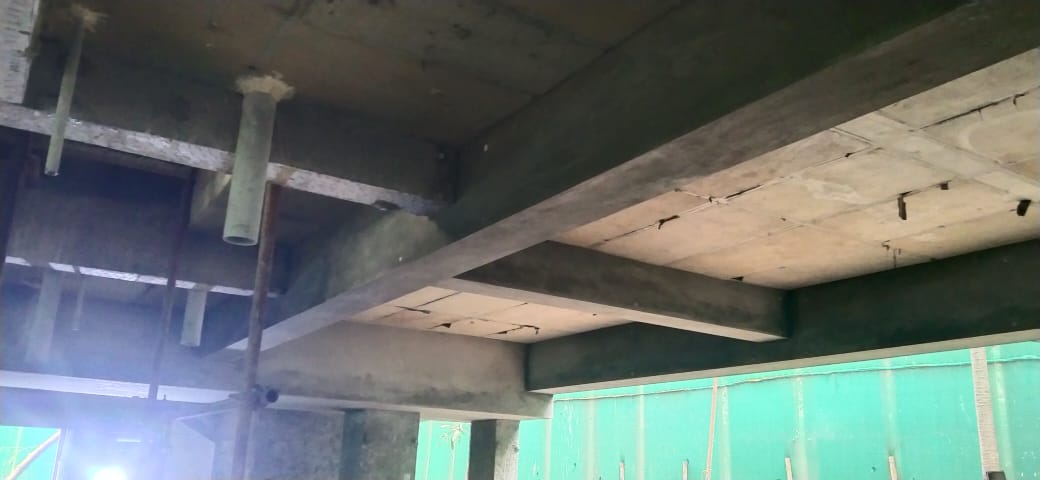

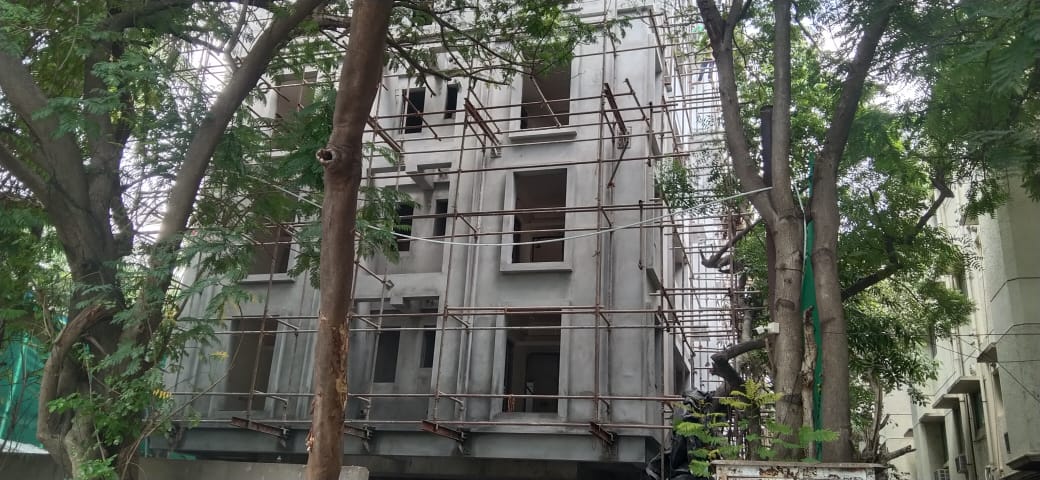

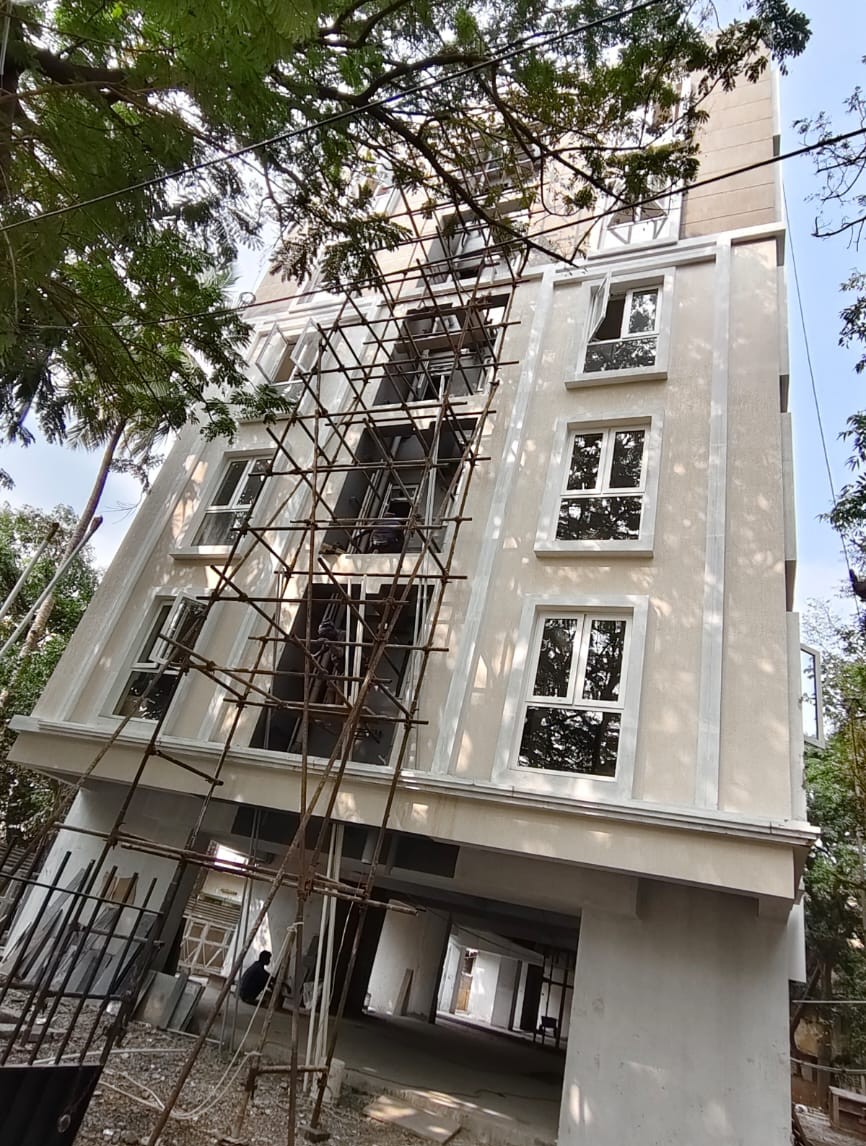

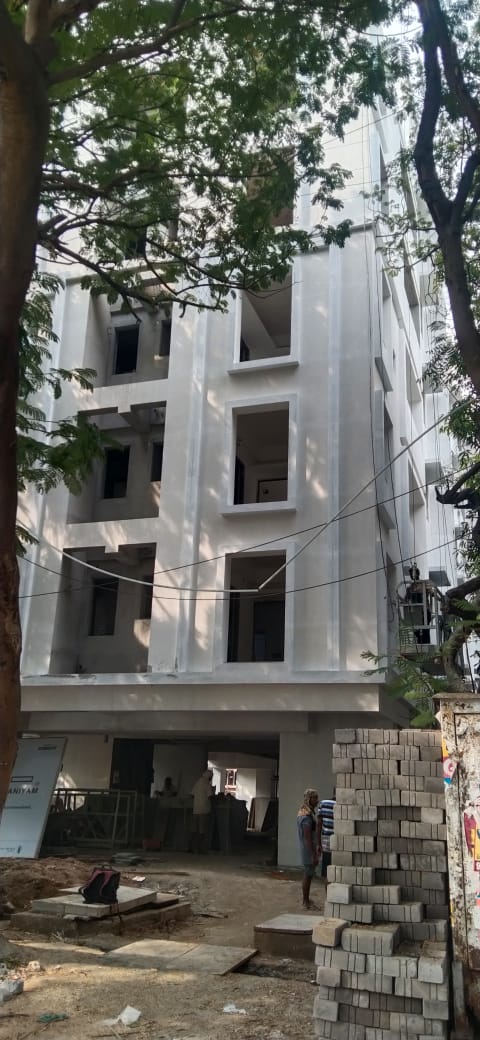

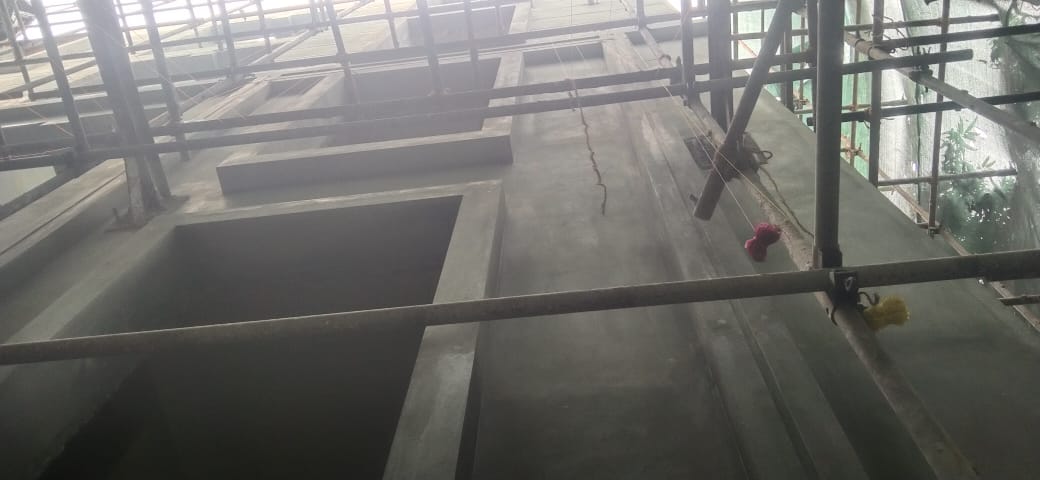

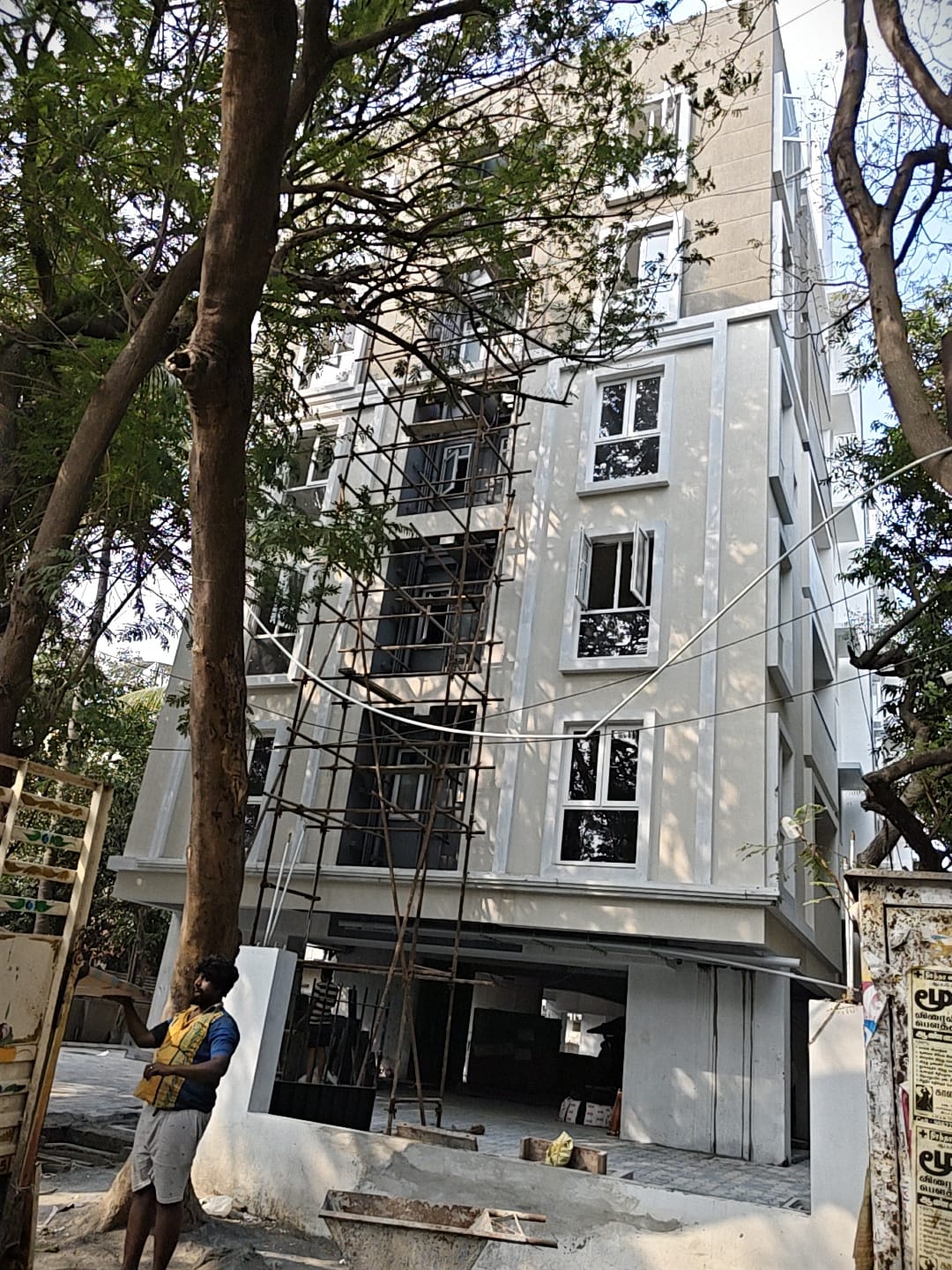

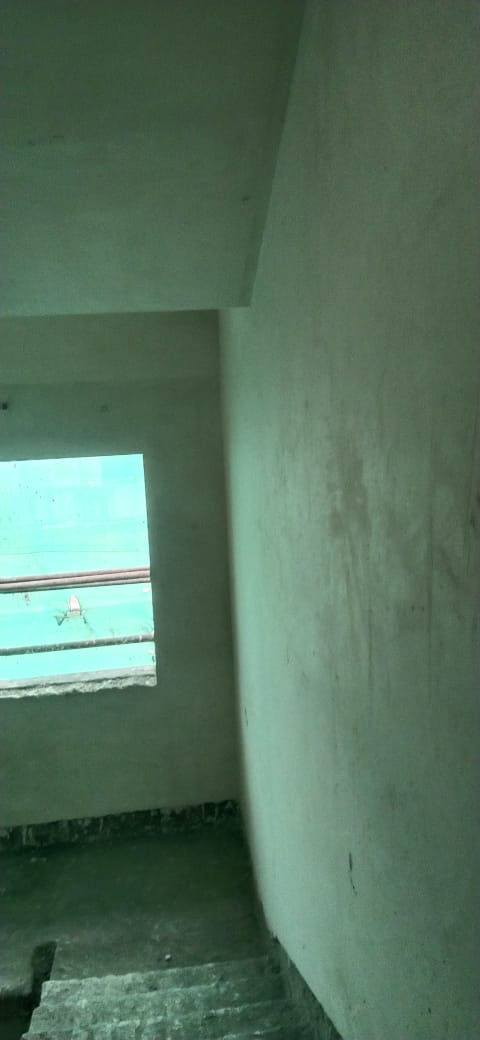

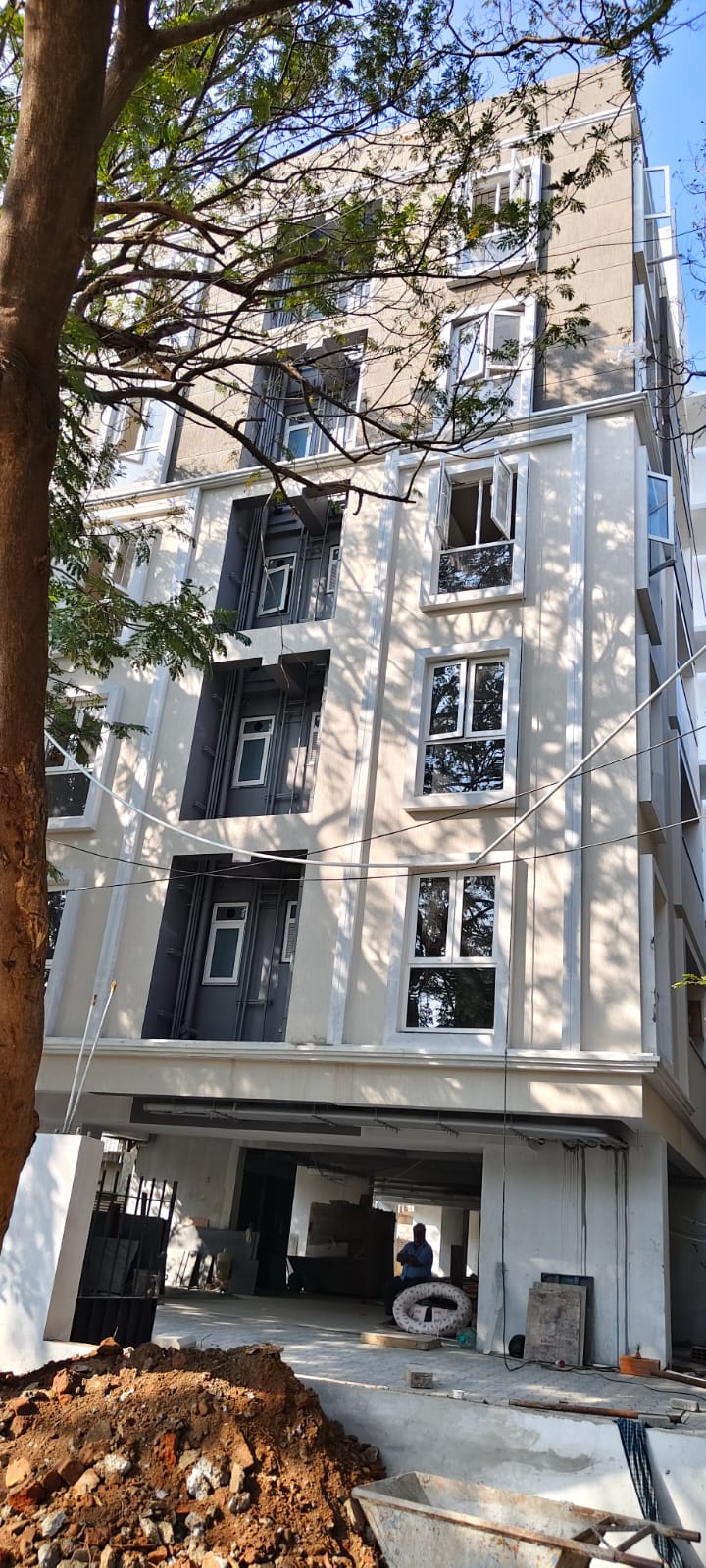

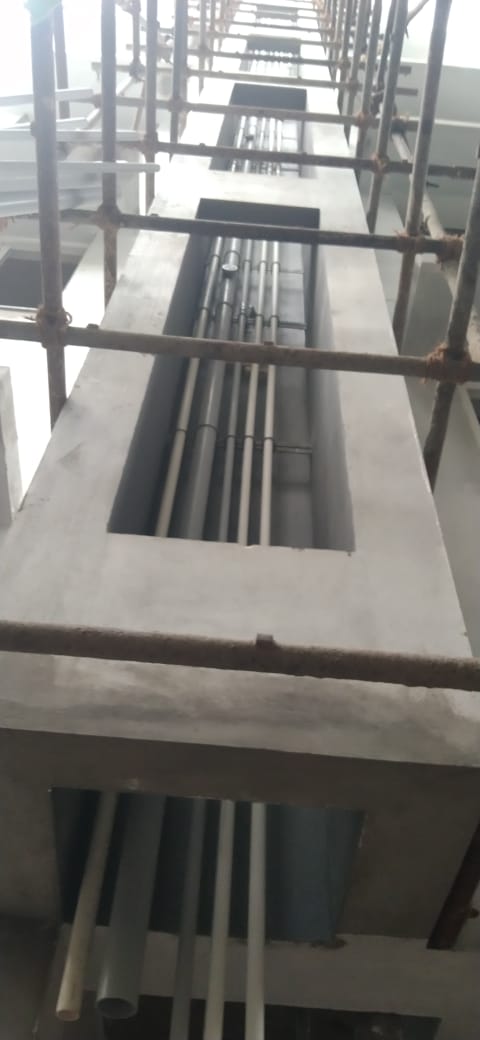

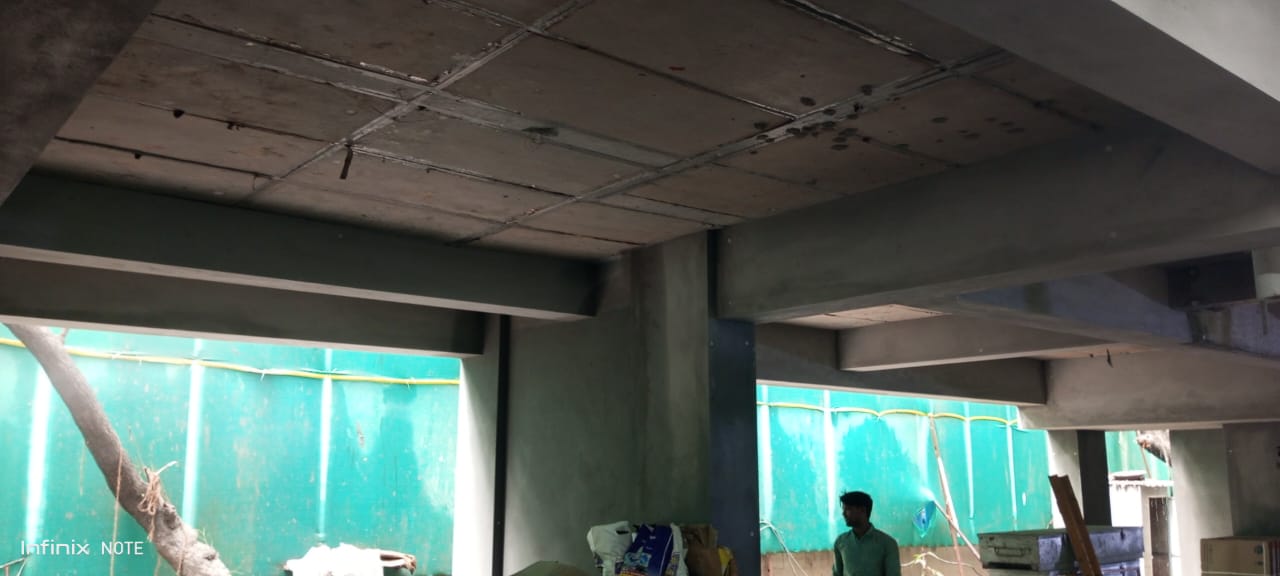

  • Stilt floor column & beam plastering work is completed.

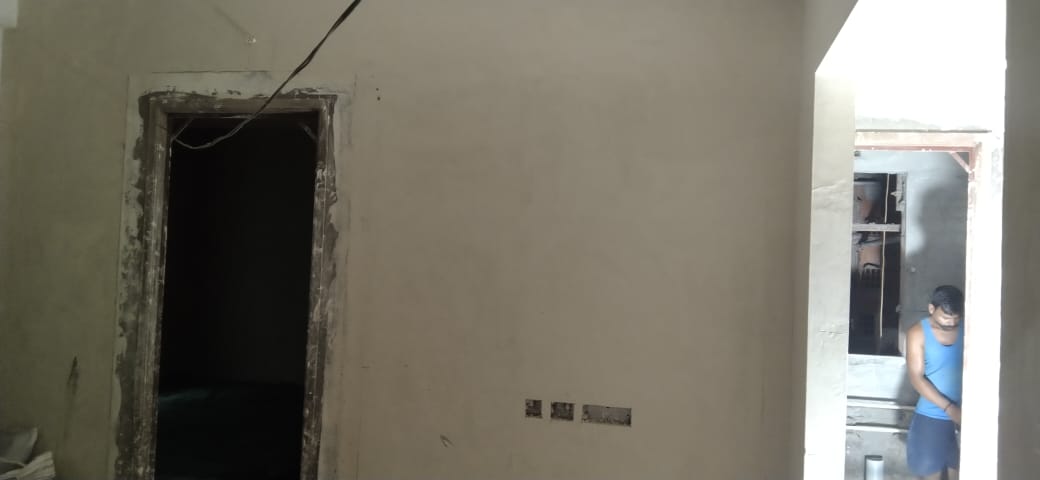

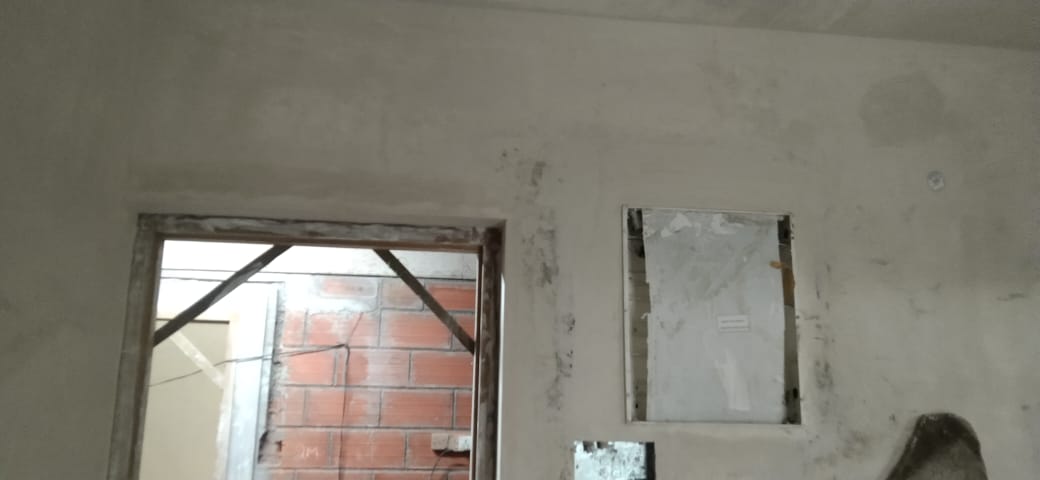

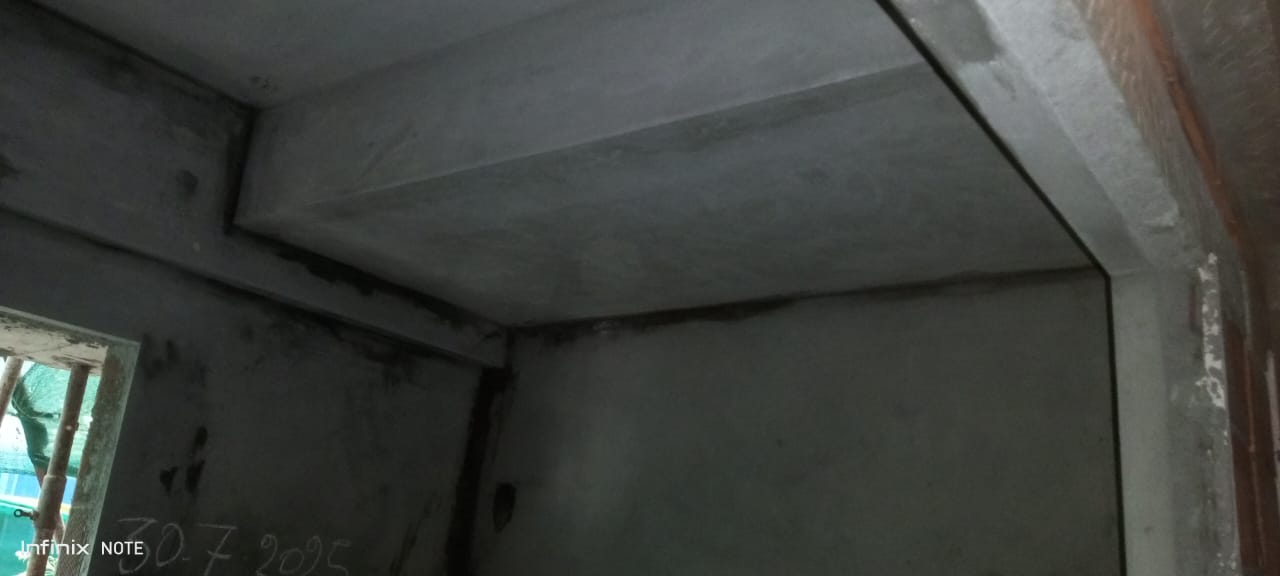

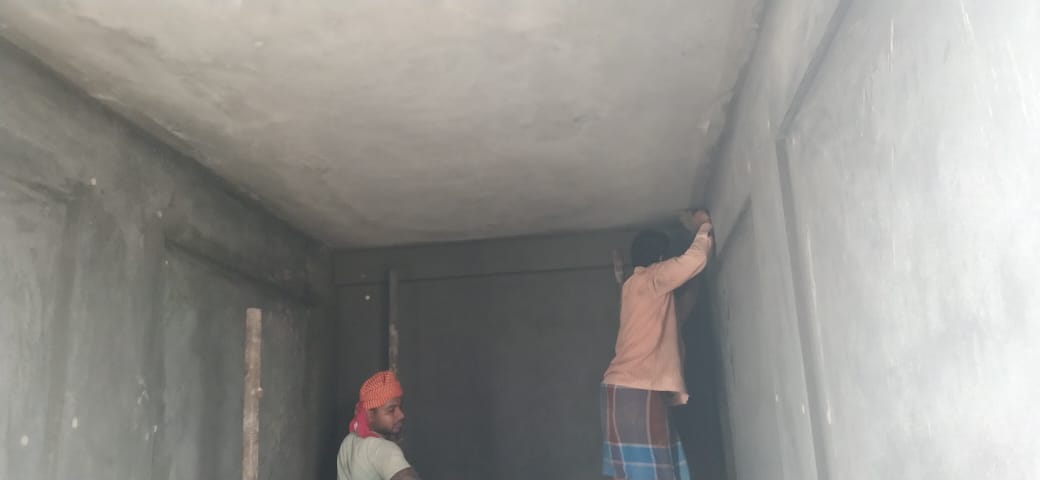

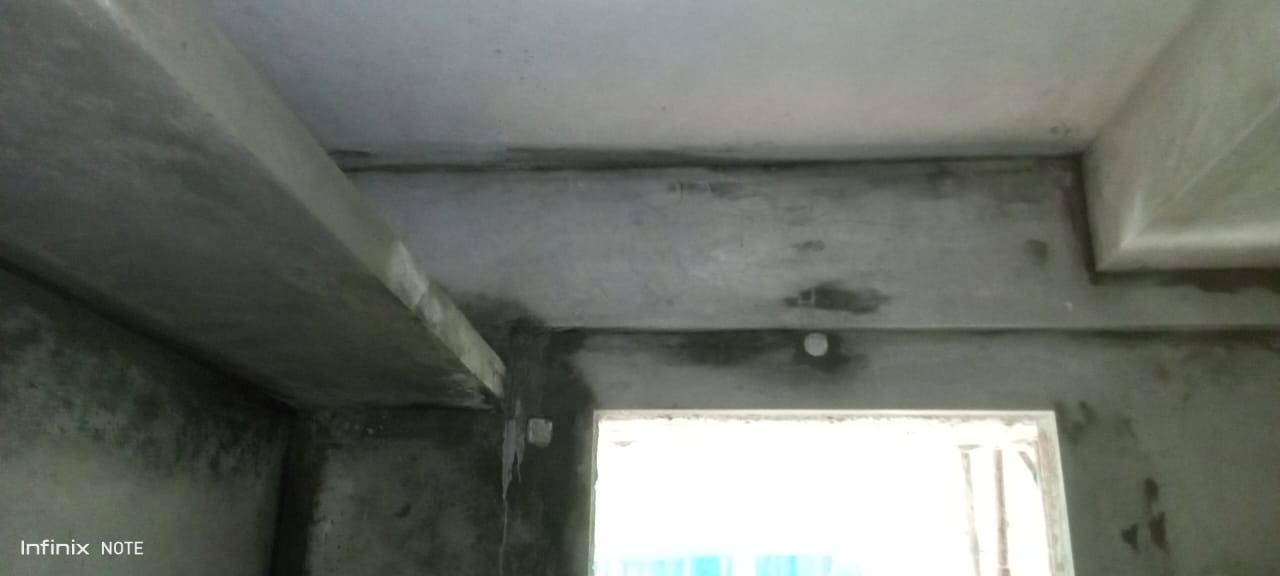

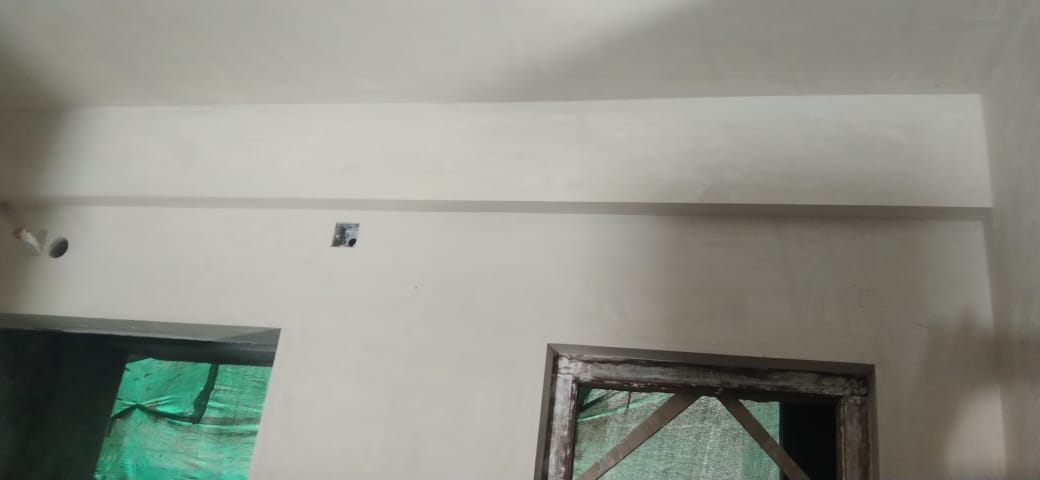

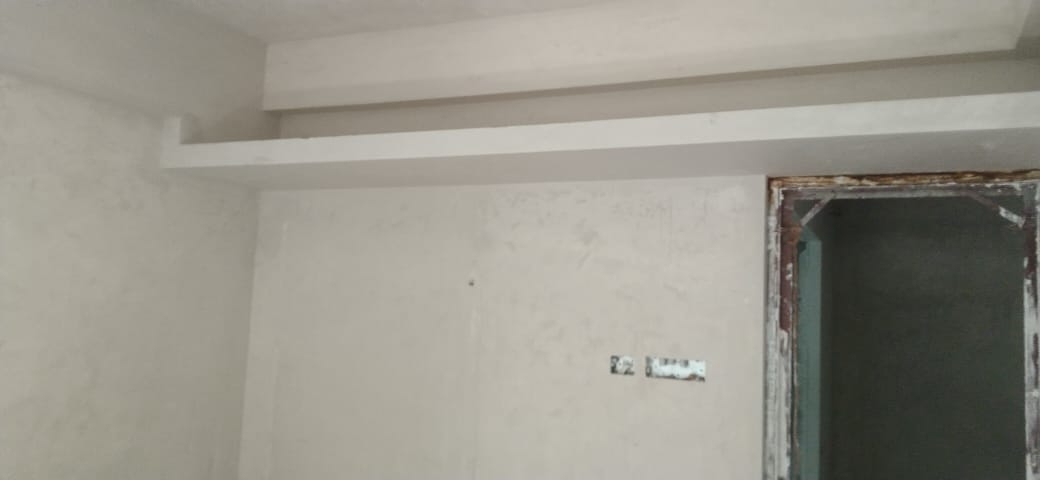

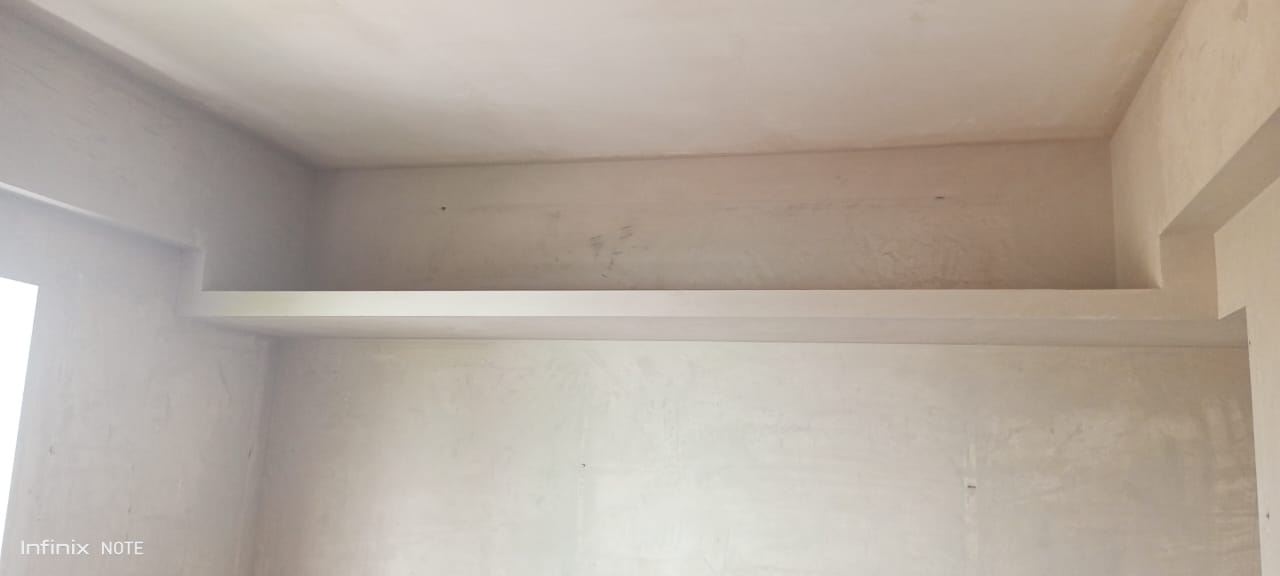

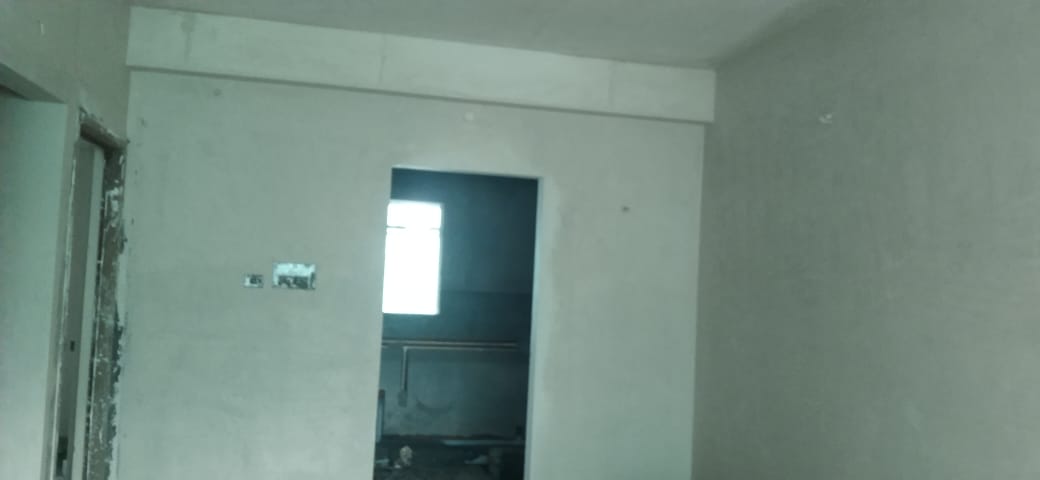

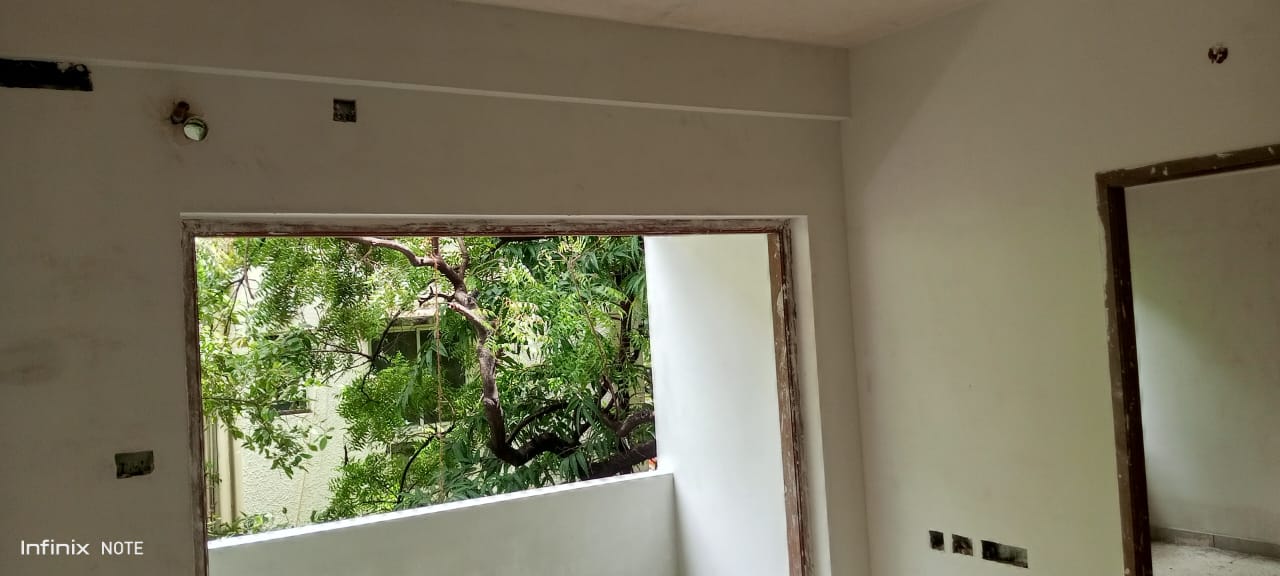

  • 5th floor inner plastering work is completed.

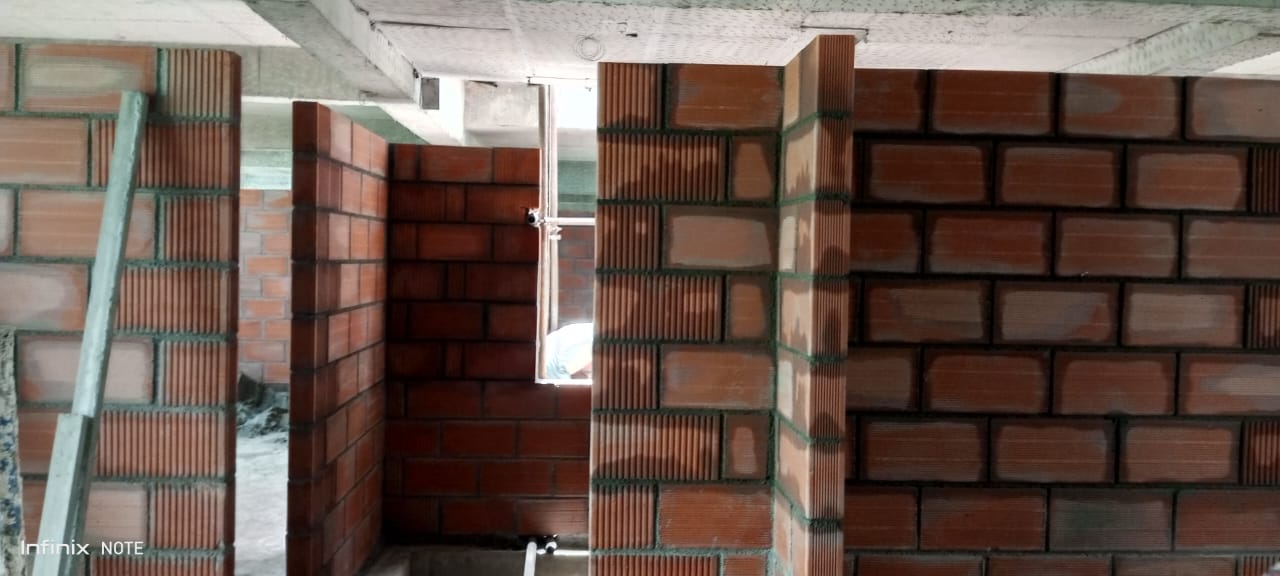

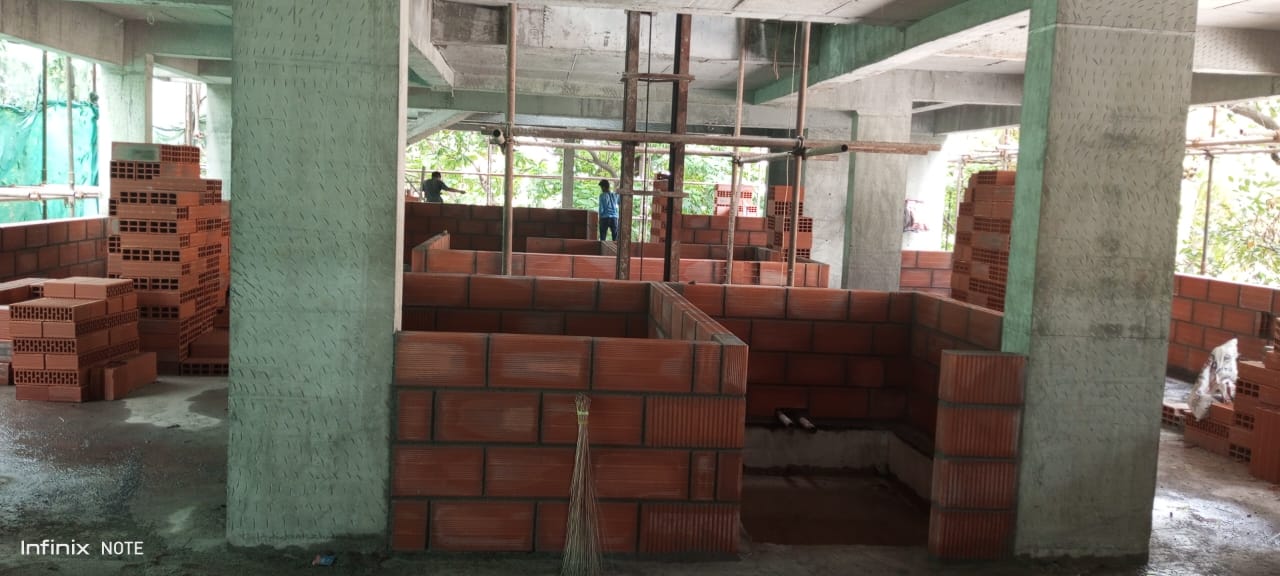

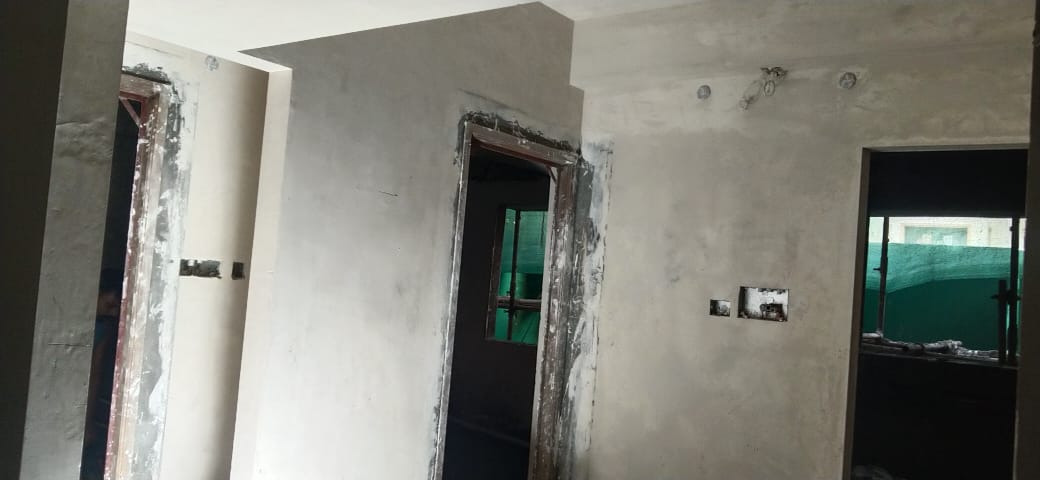

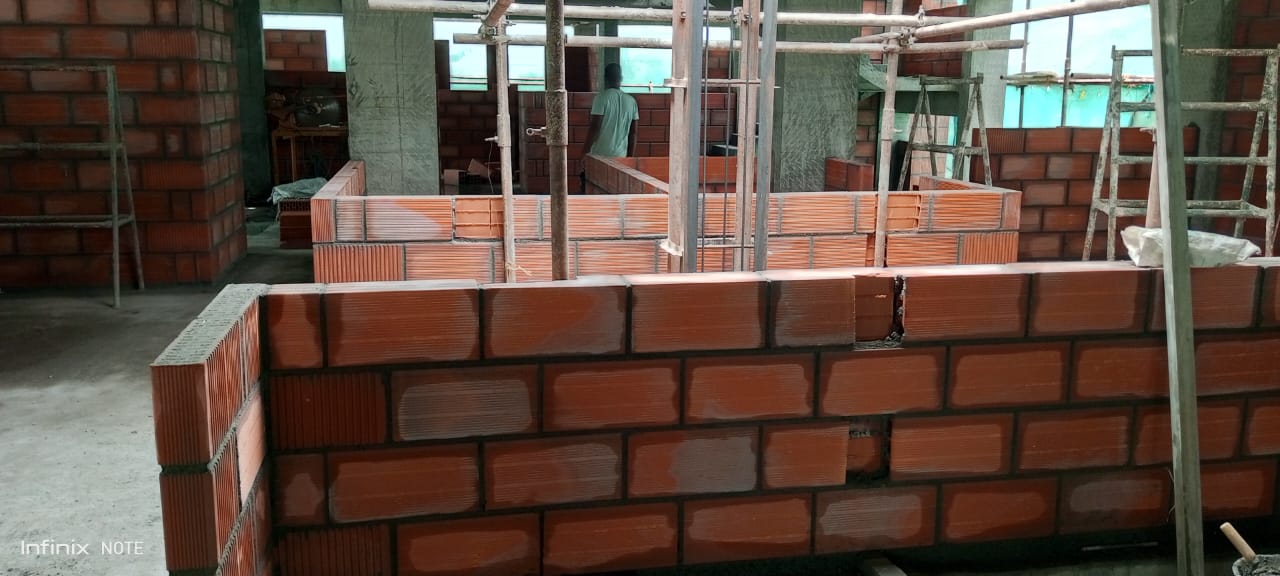

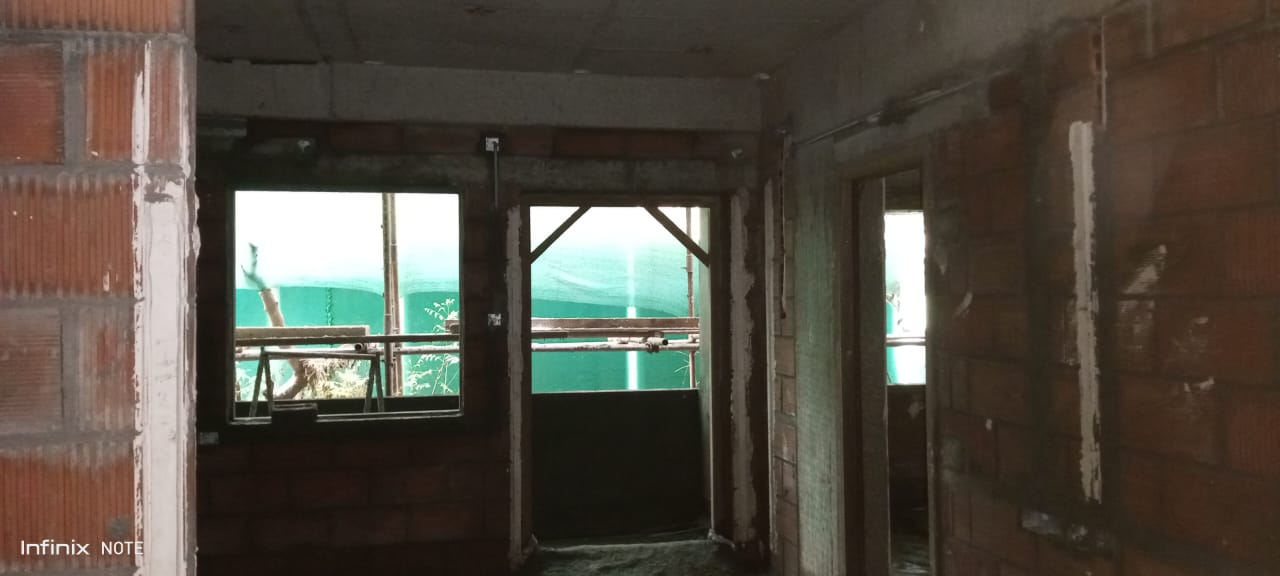

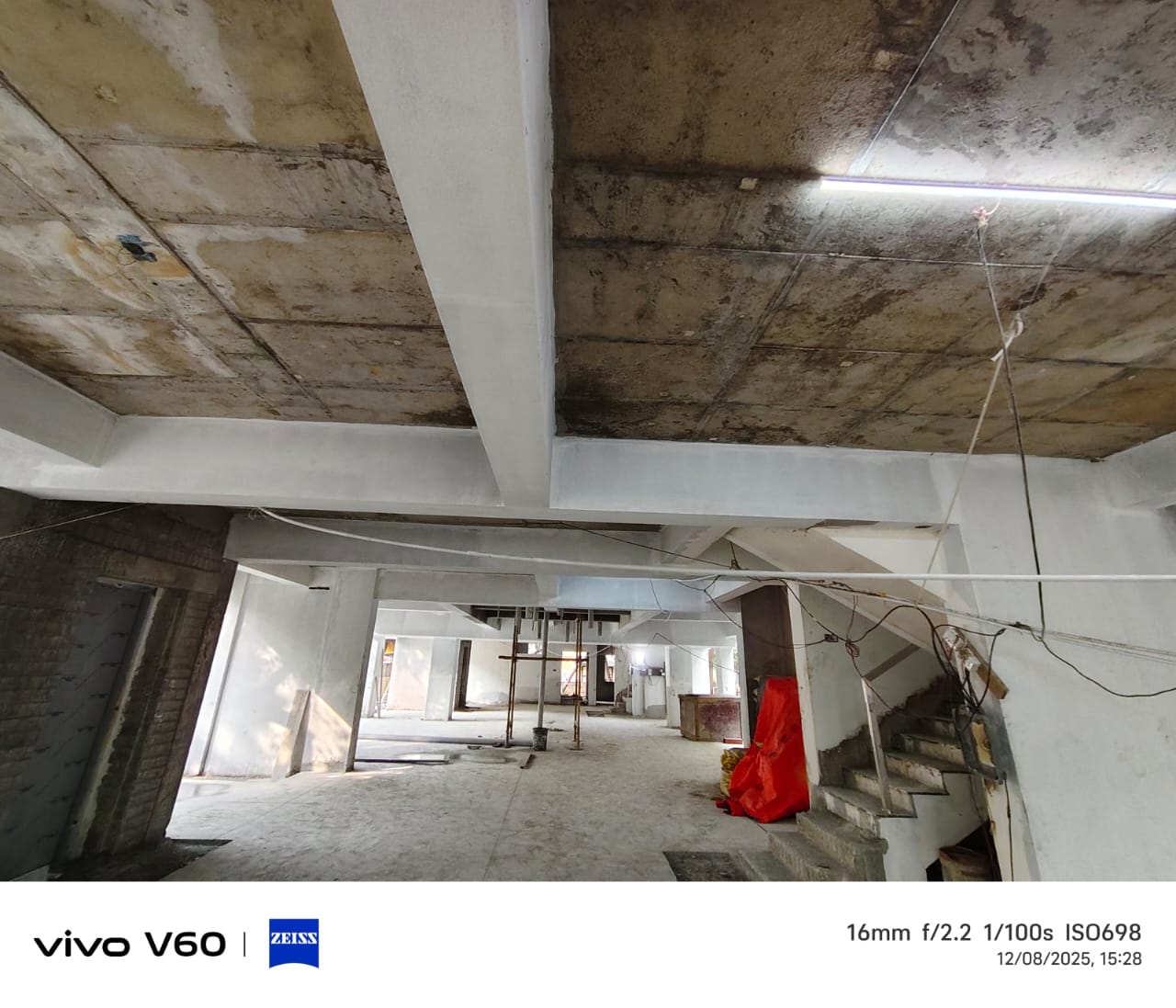

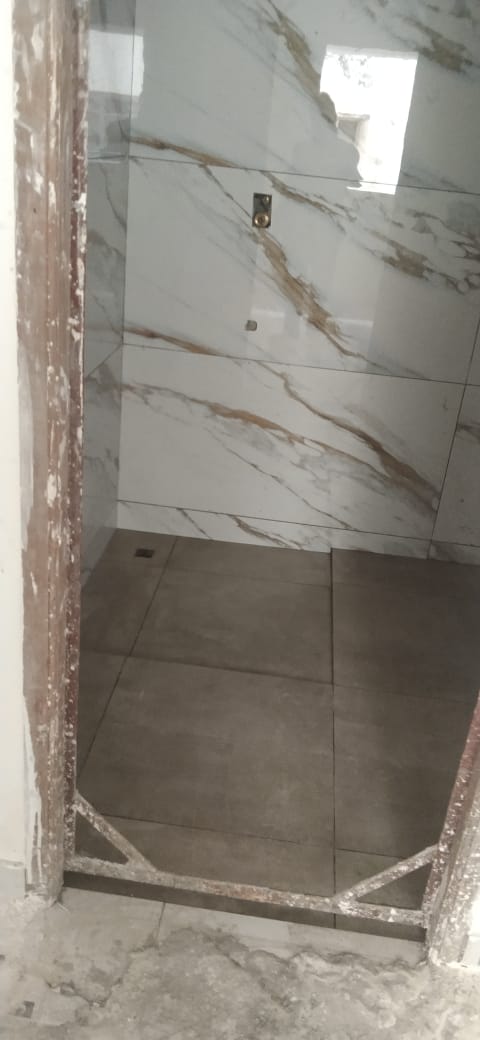

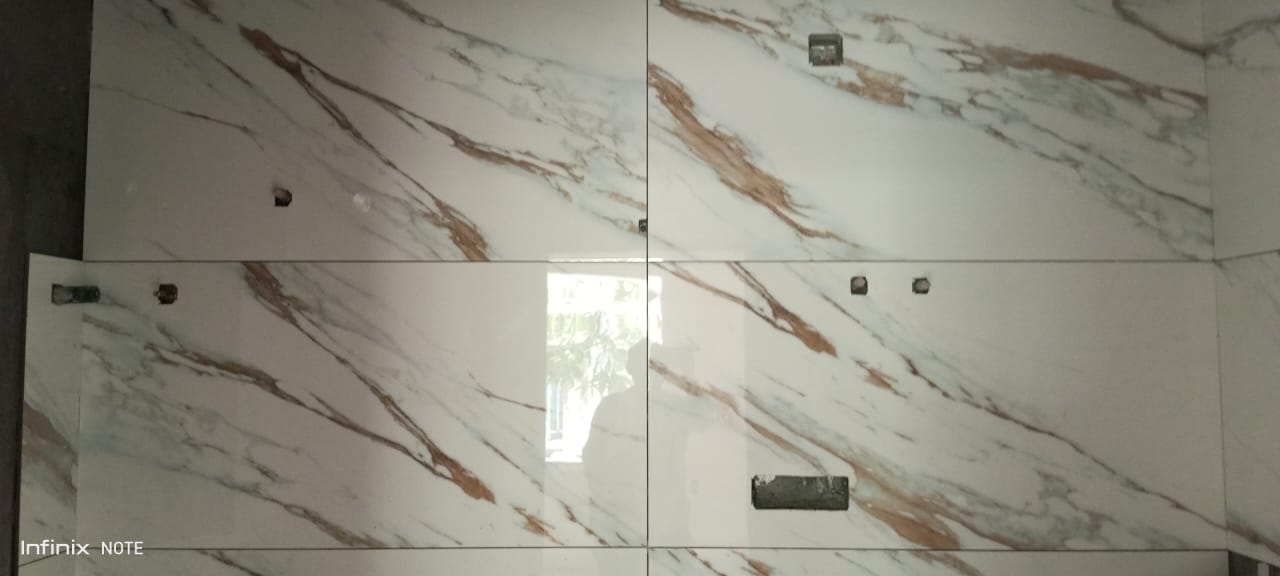

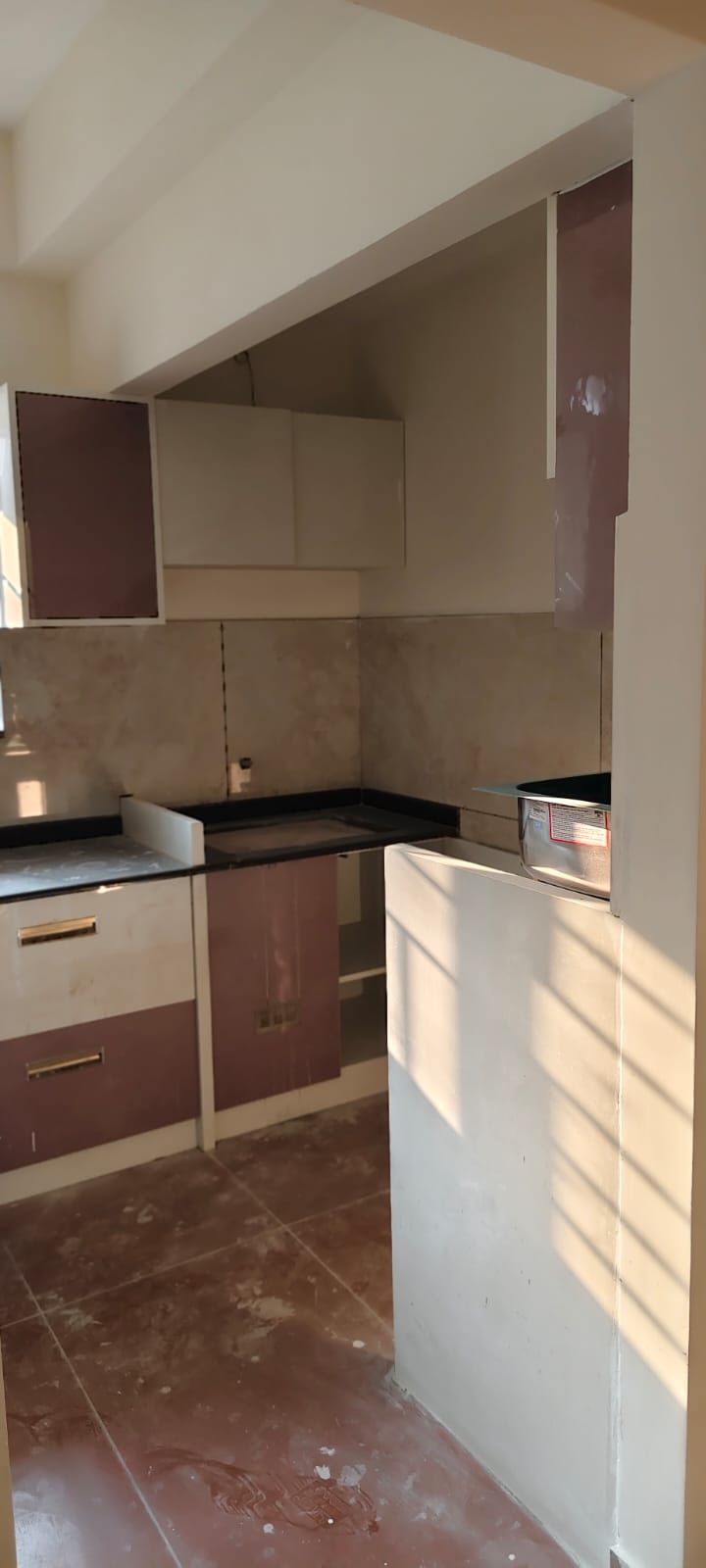

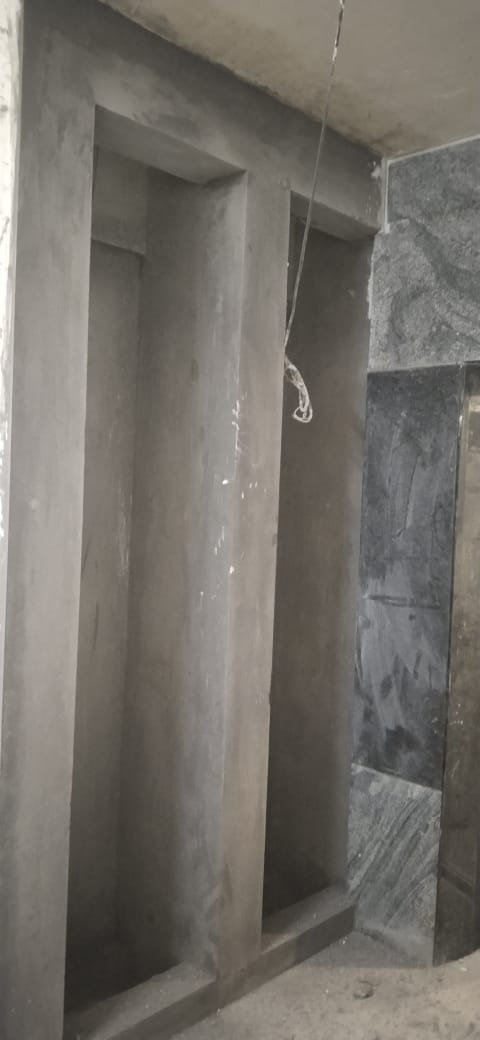

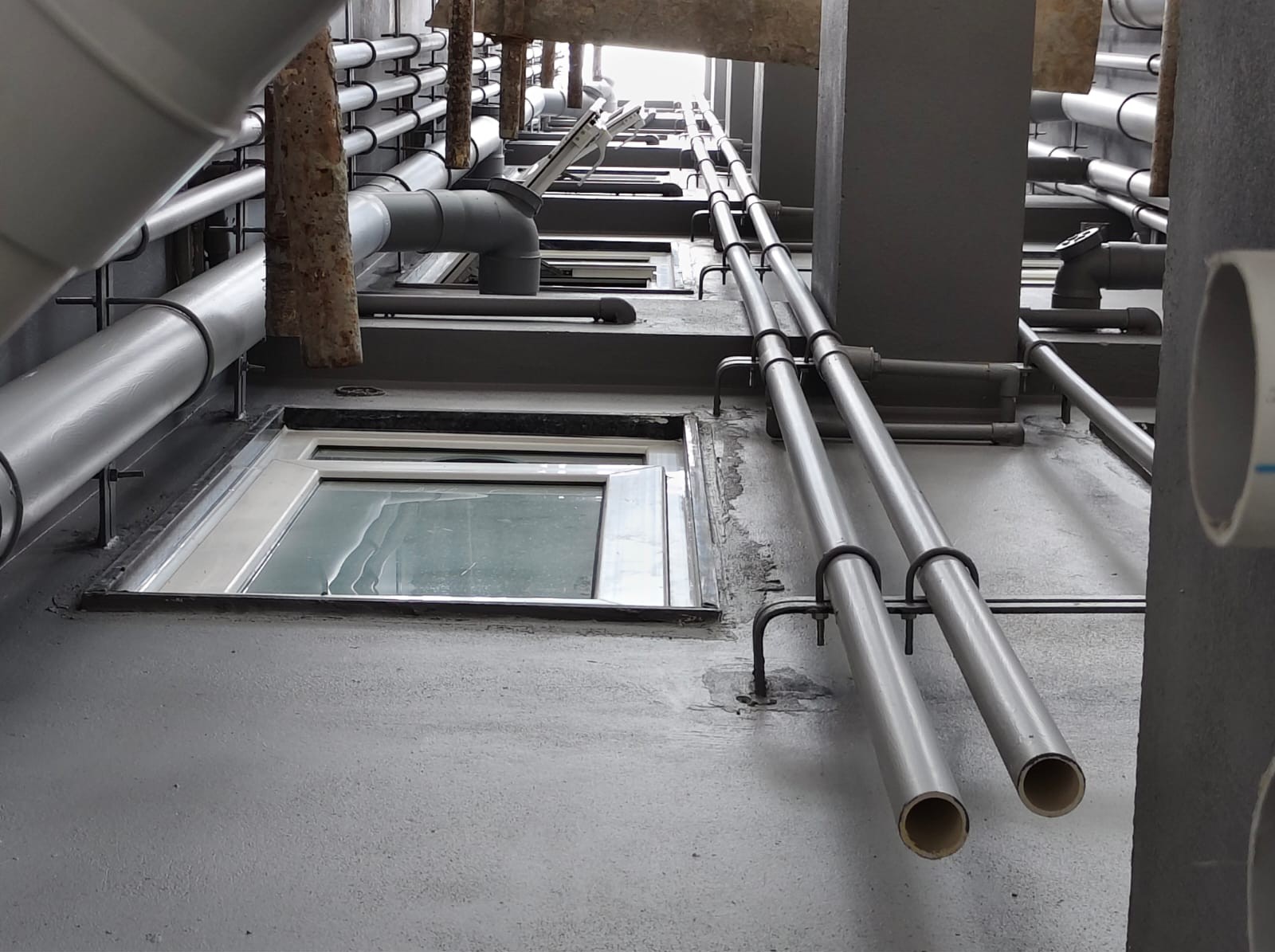

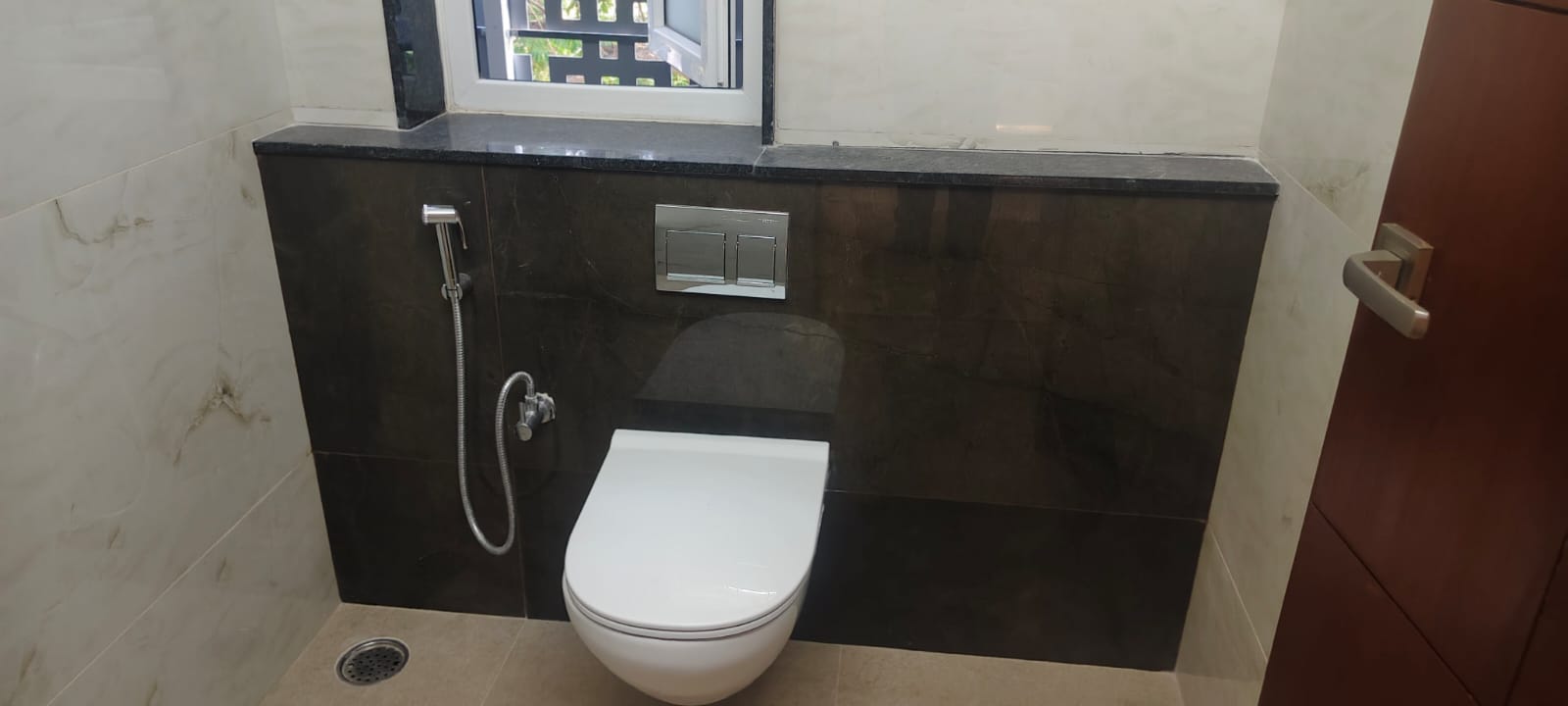

  • Toilet wall tiles work is in progress. (upto 4th floor completed)

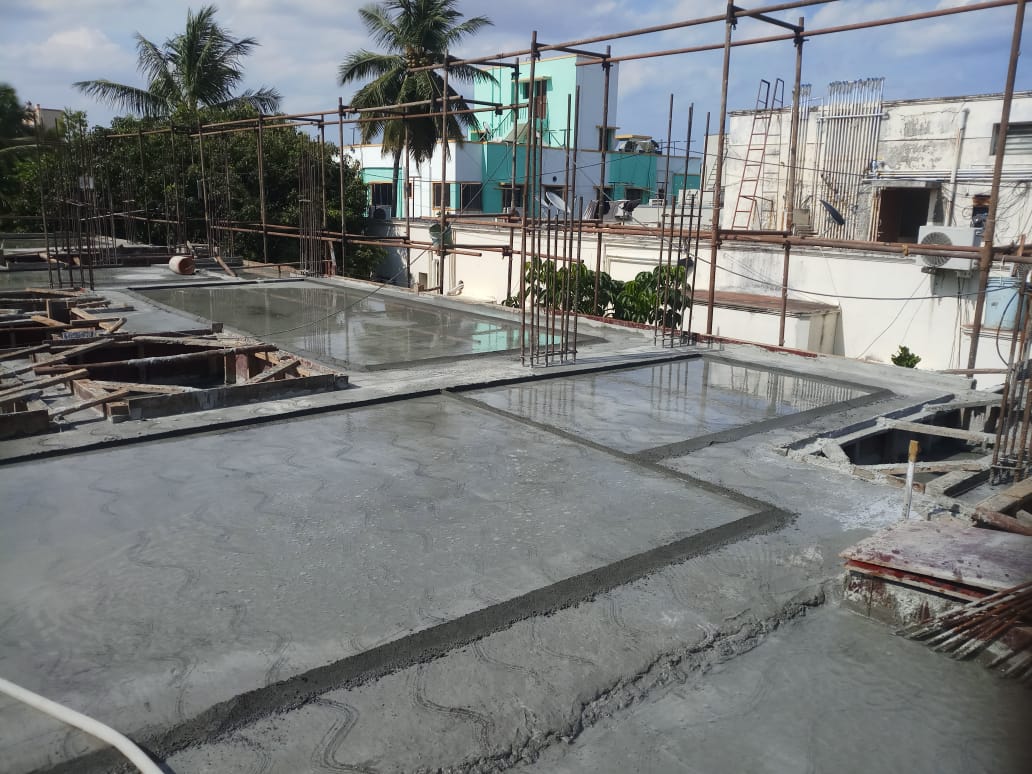

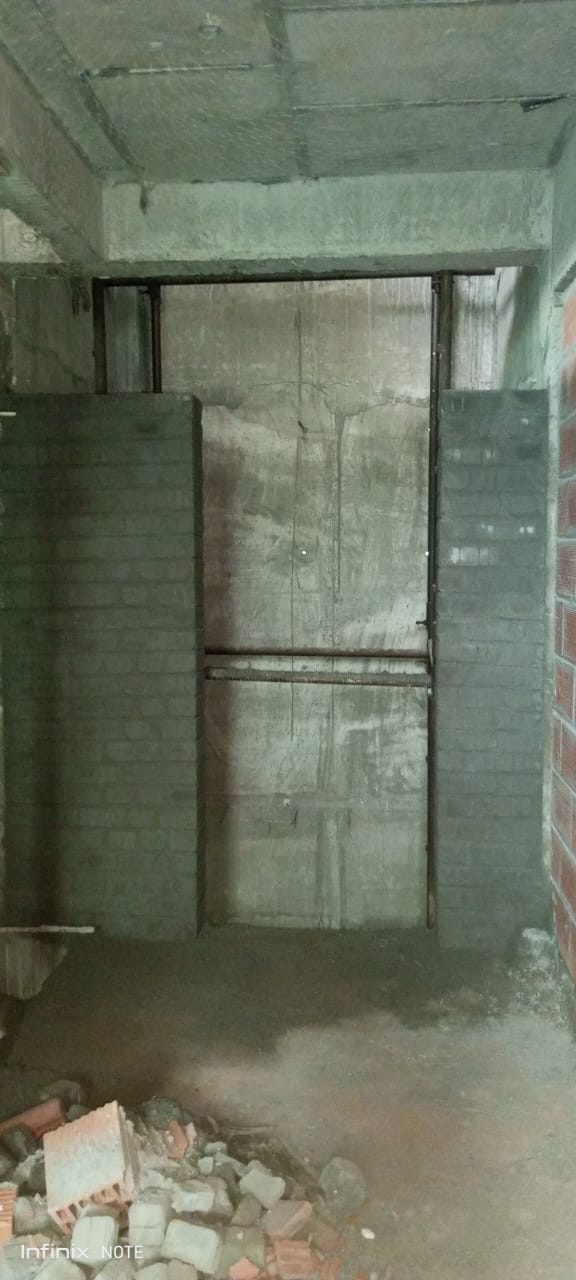

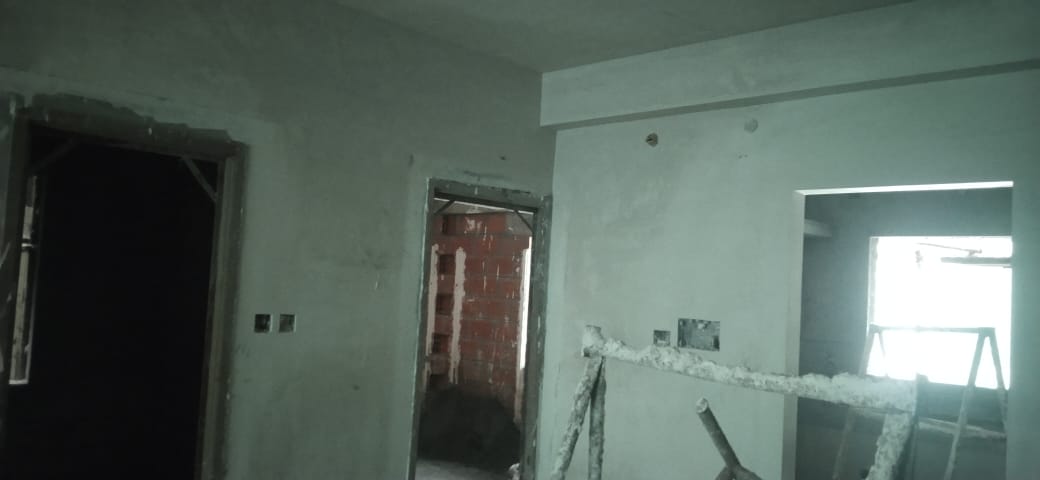

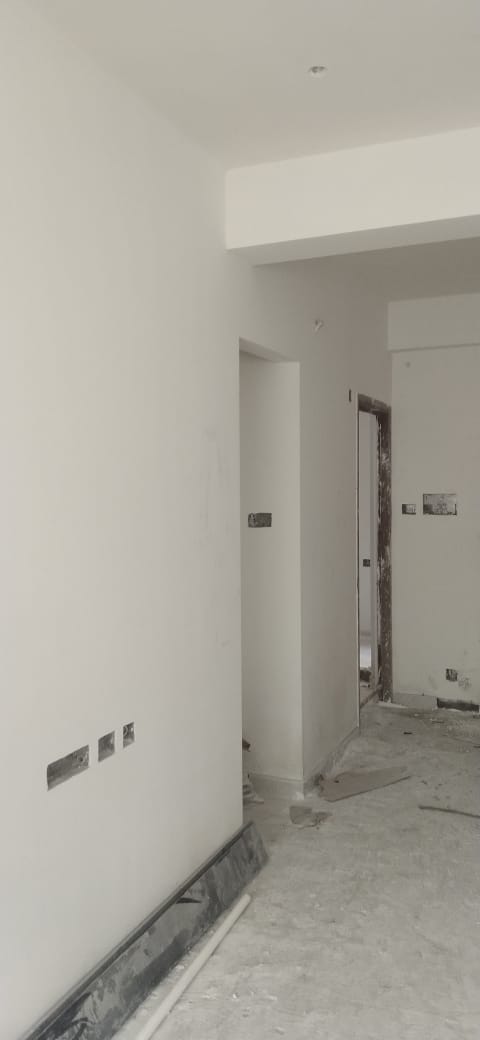

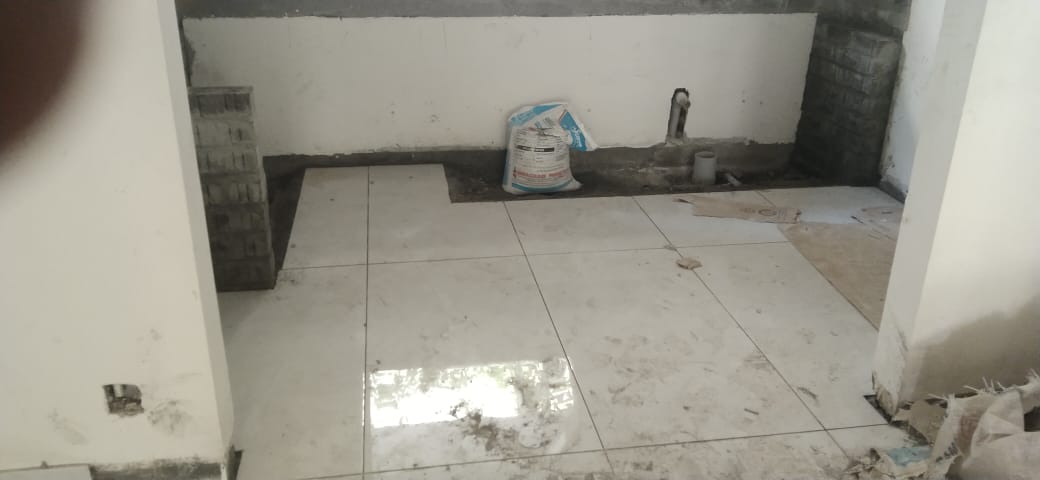

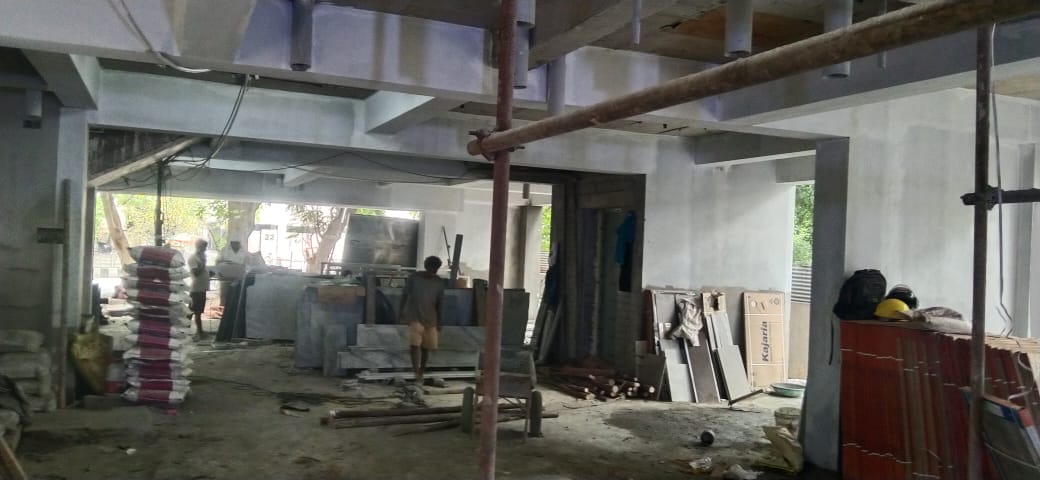

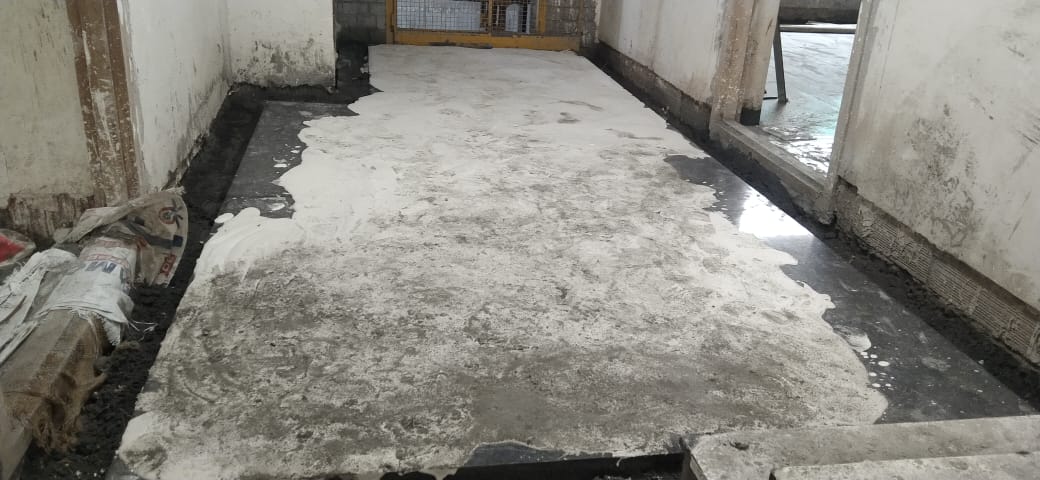

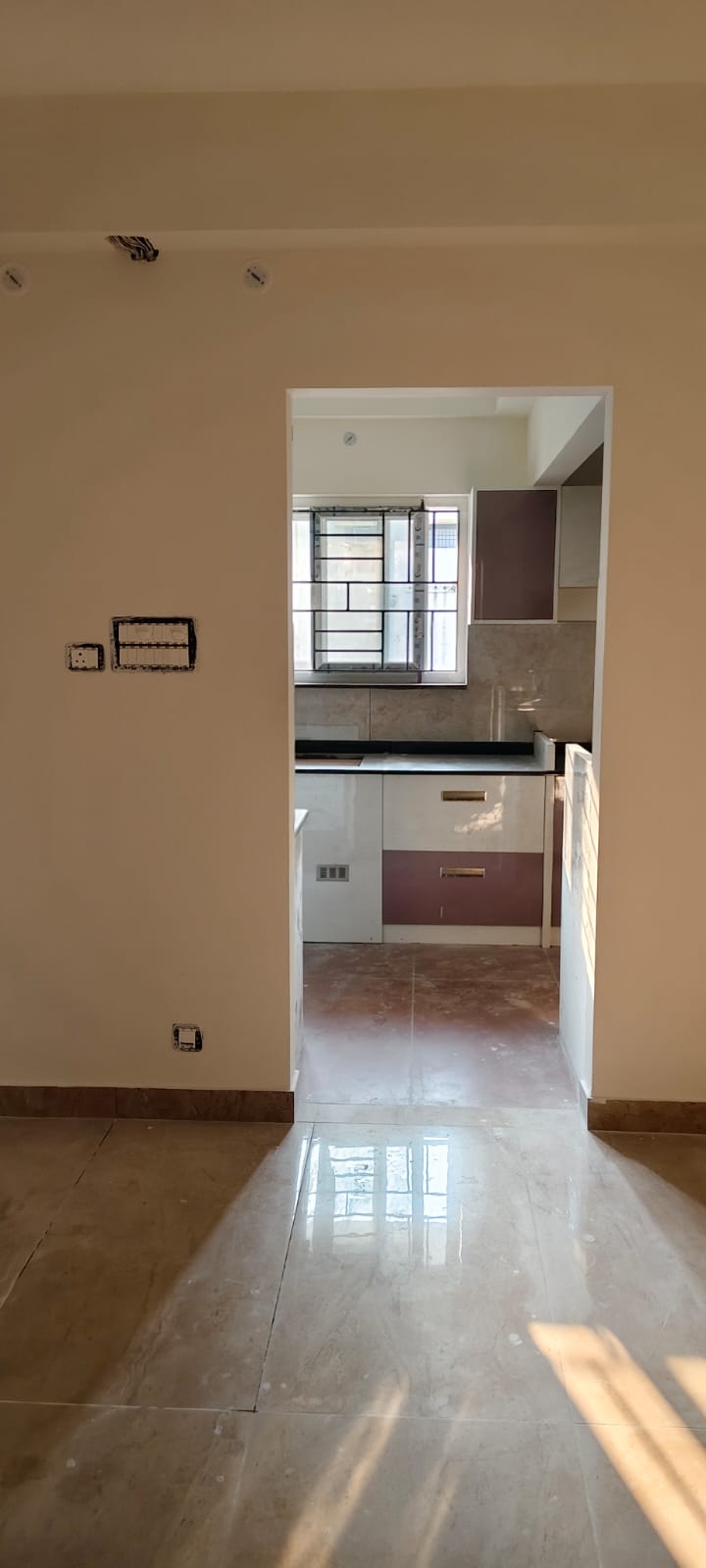

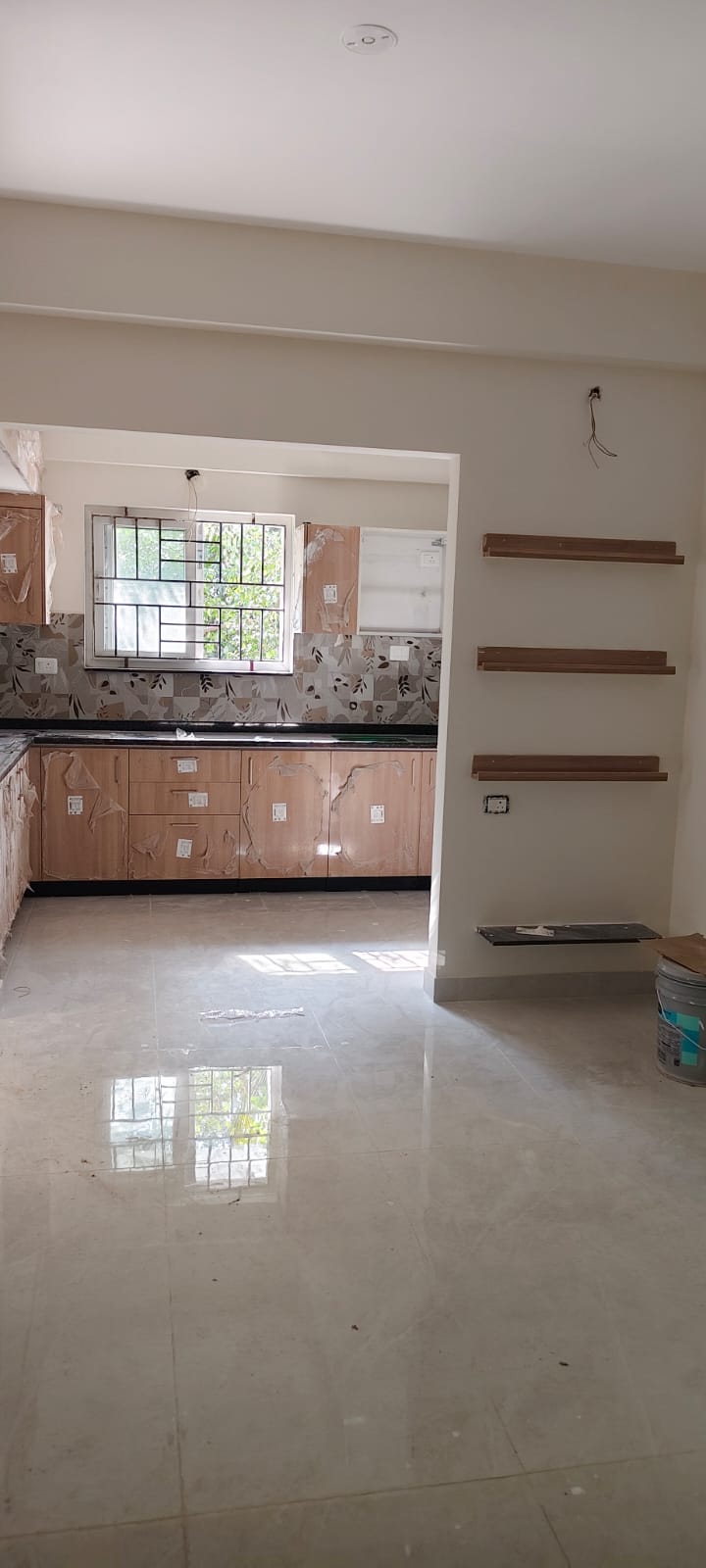

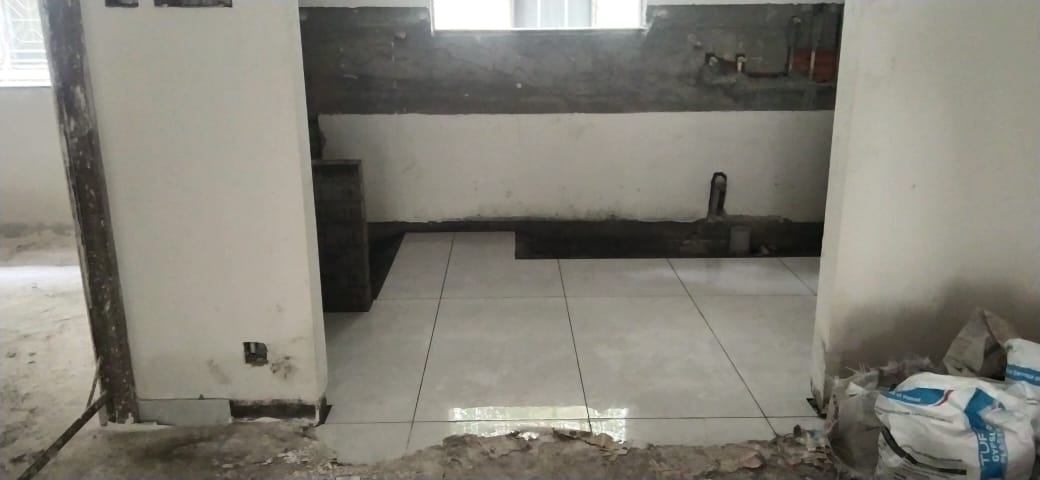

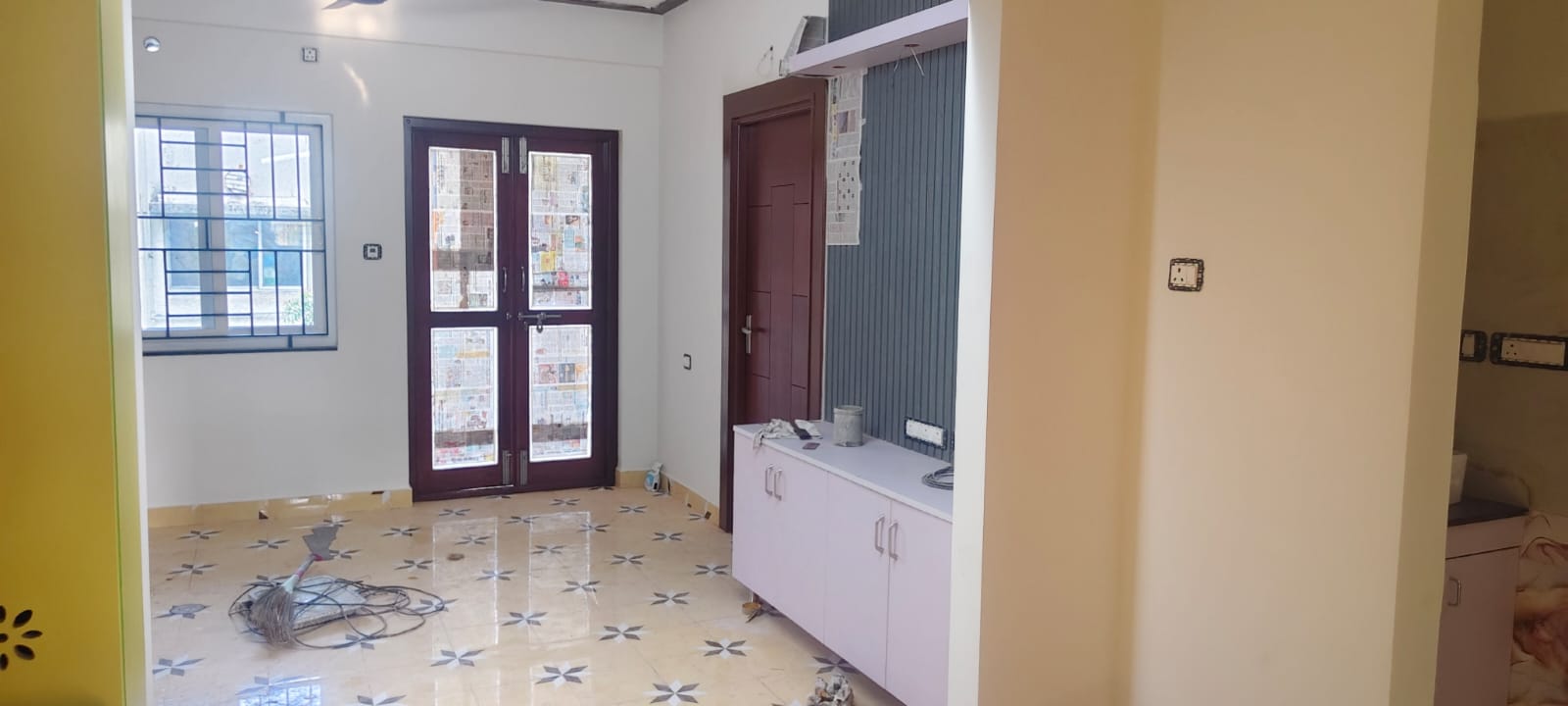

  • 4thfloor general flooring work is in progress. (upto 3rd floor completed)

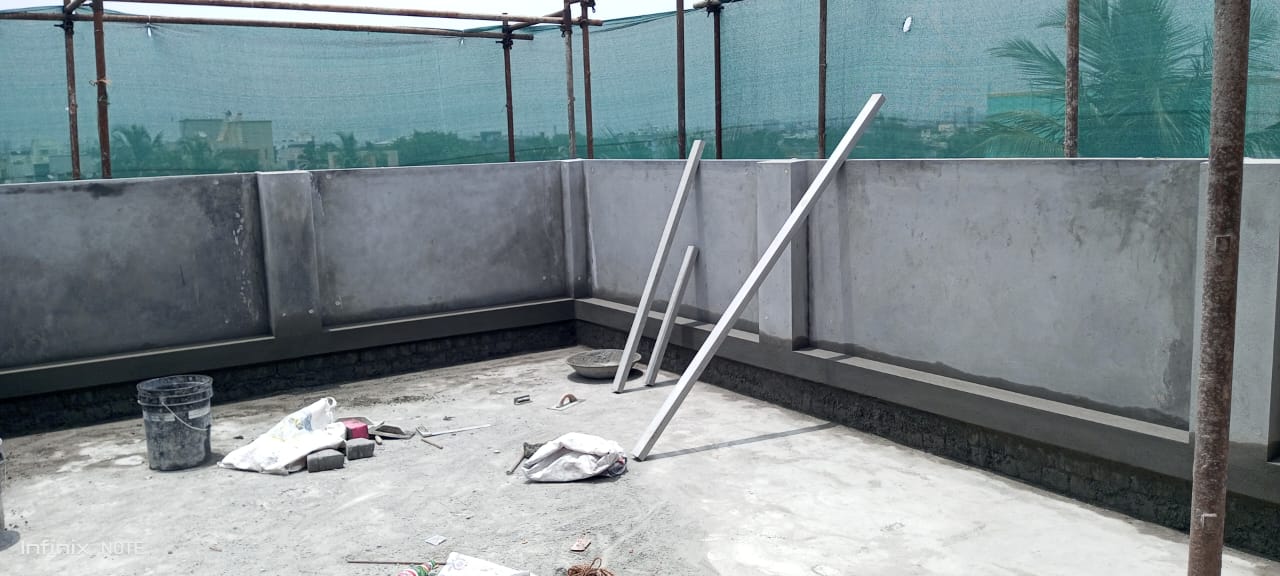

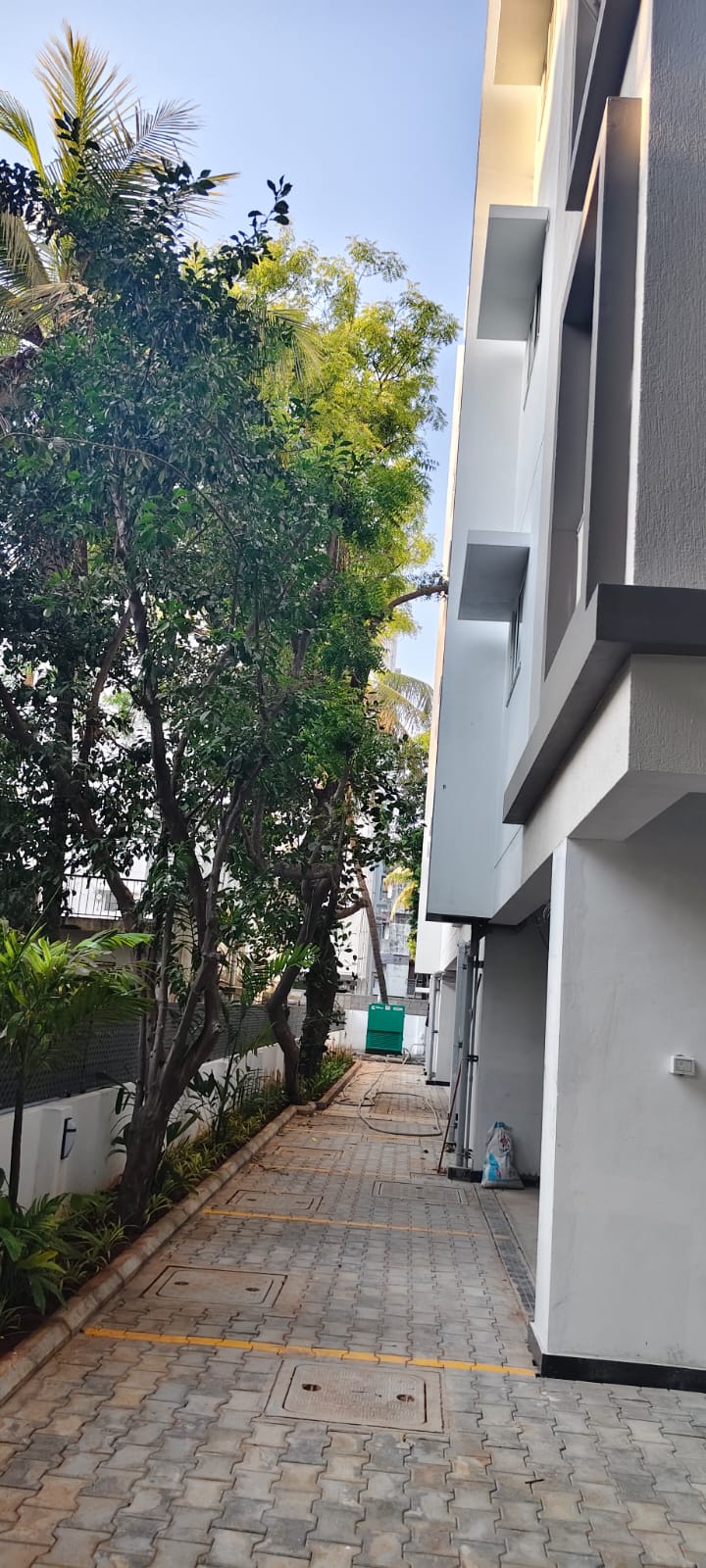

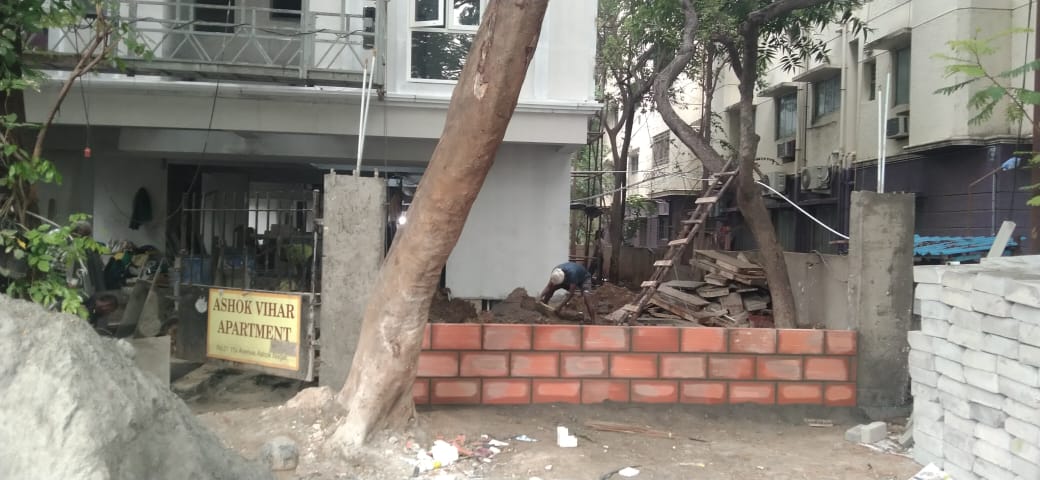

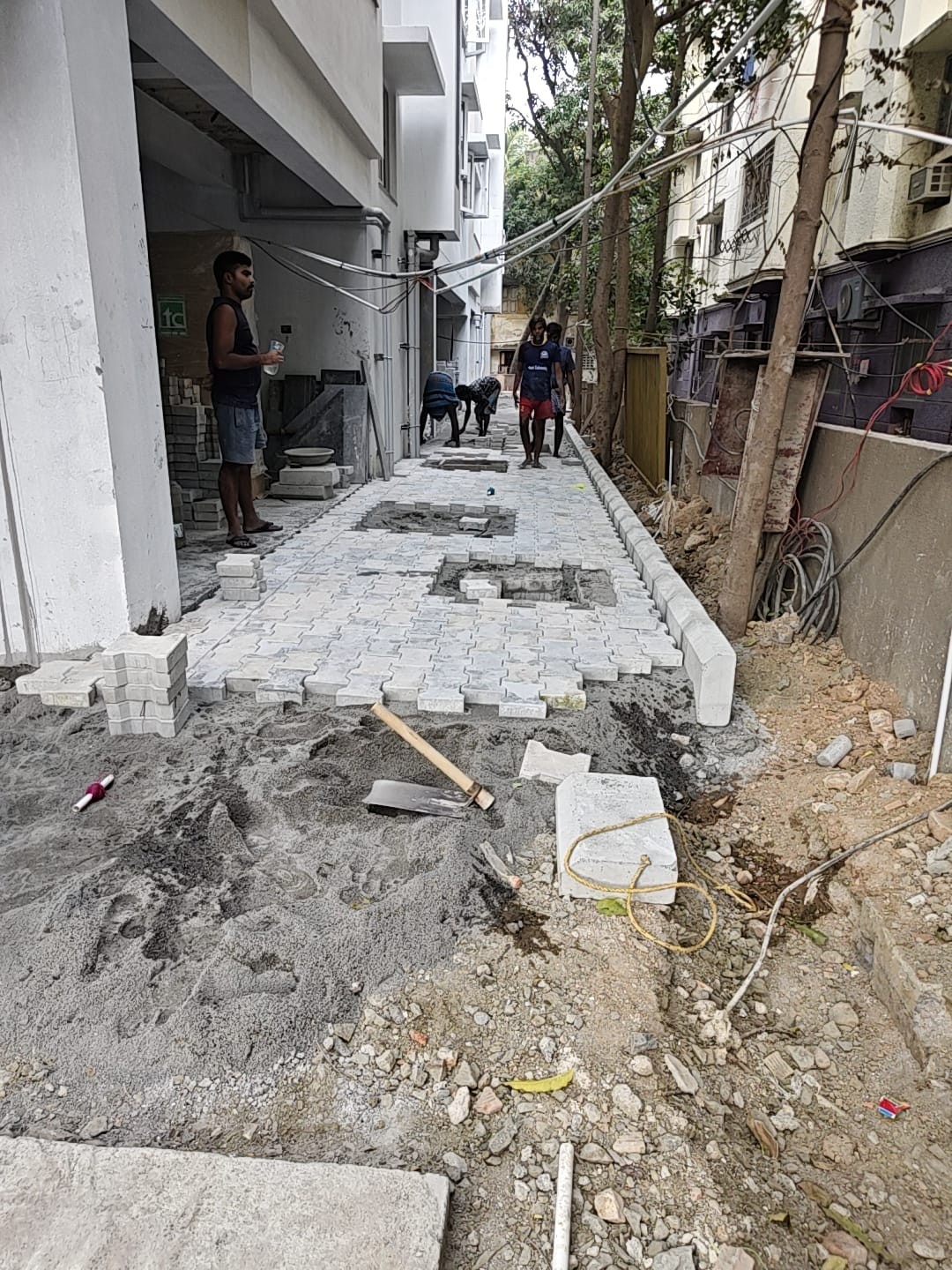

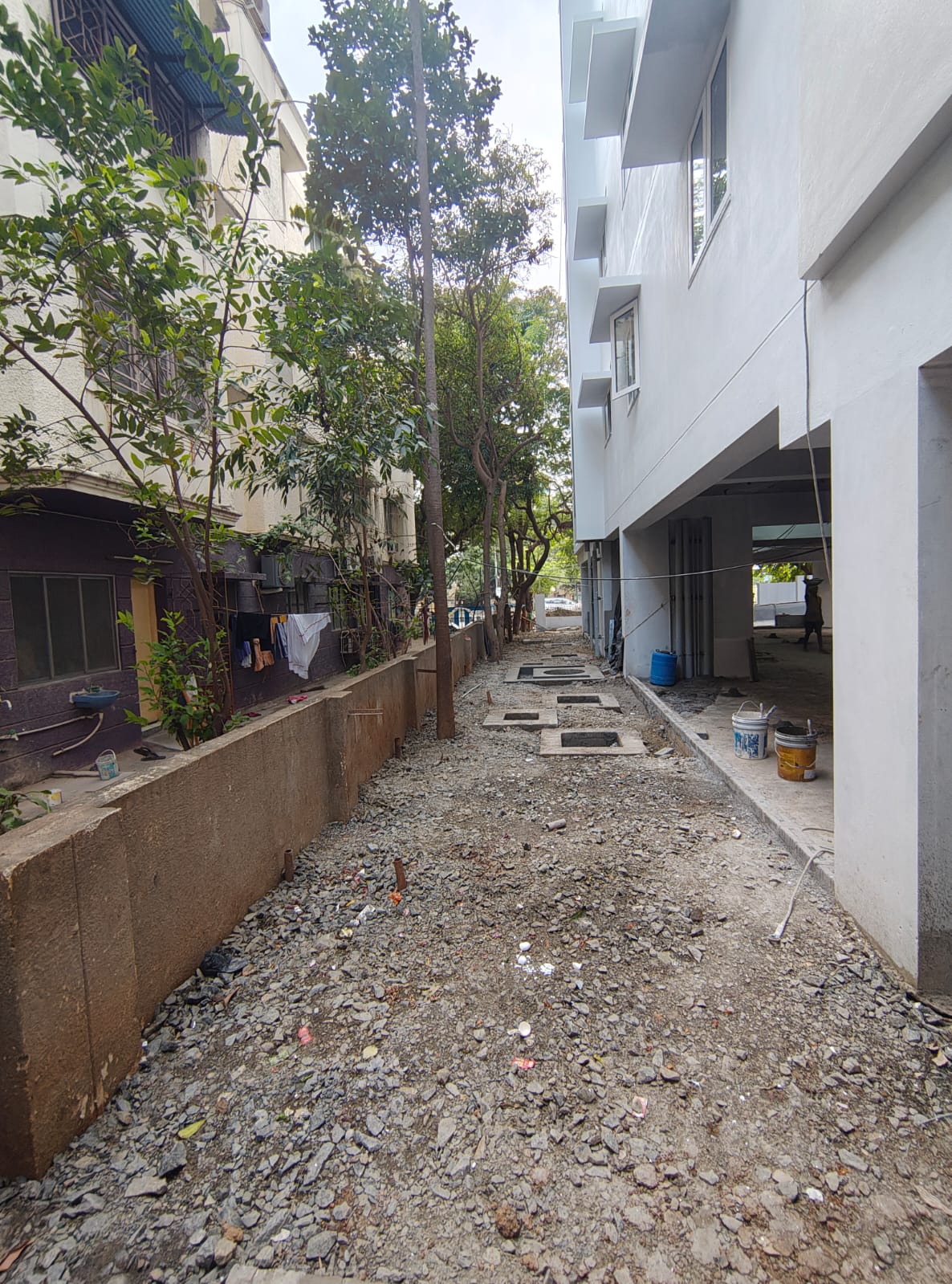

  • Compound wall work is in progress.(south side progress)

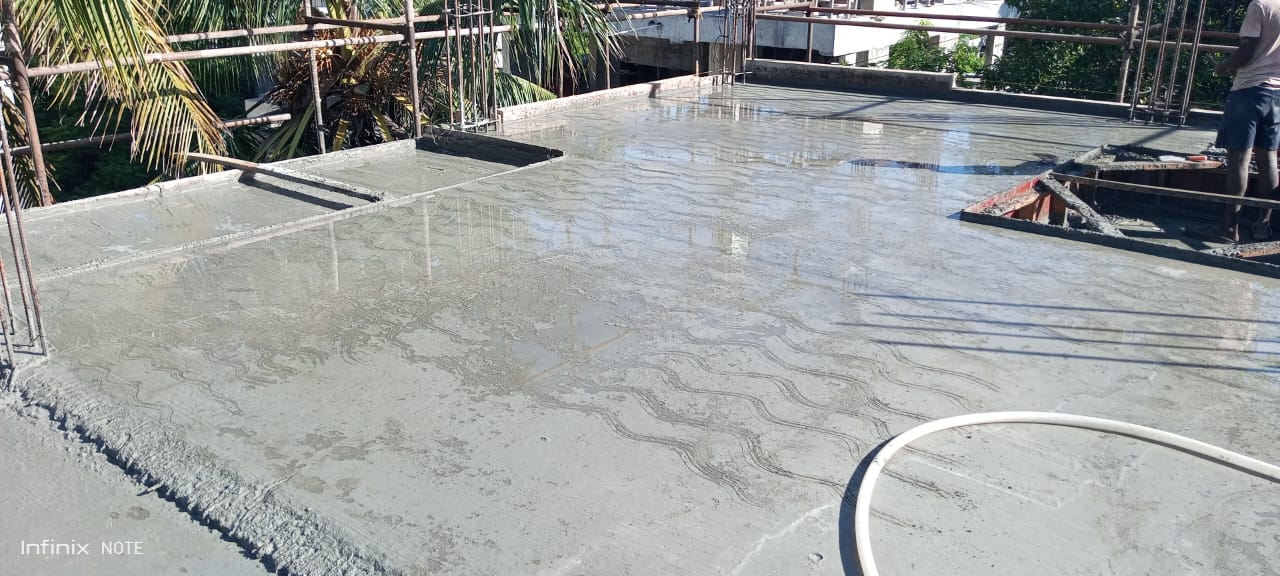

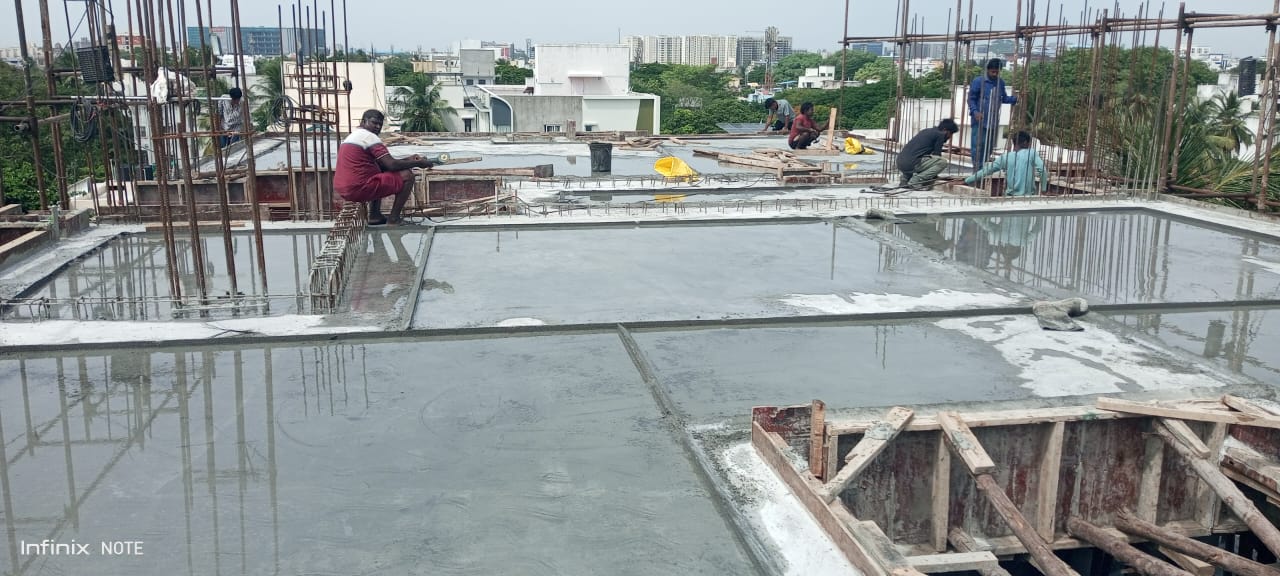

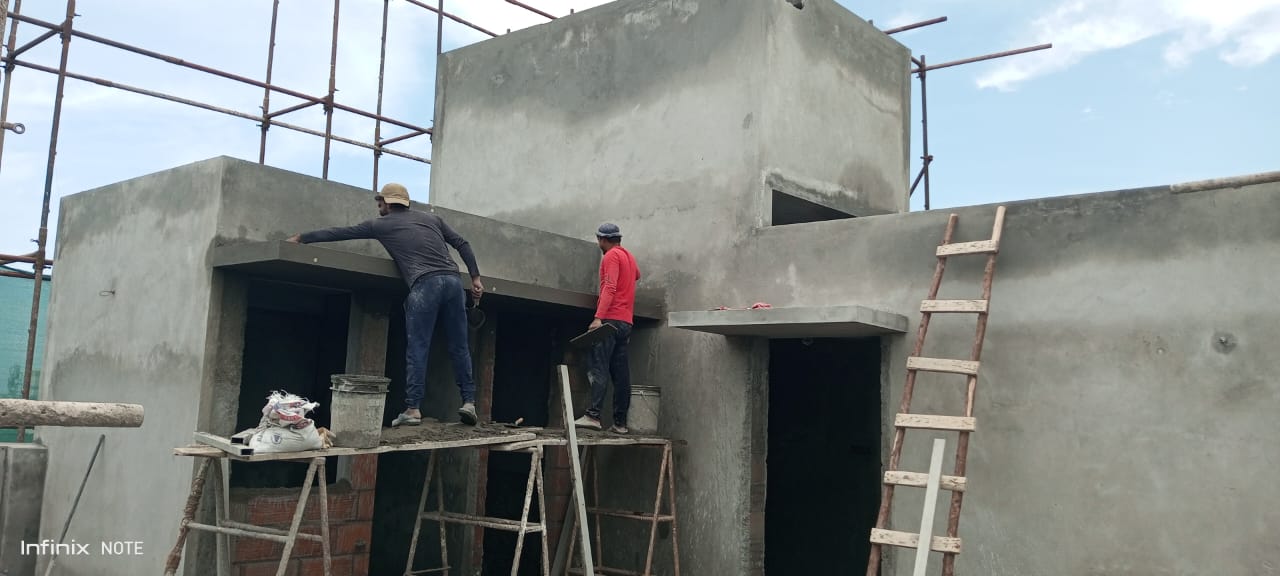

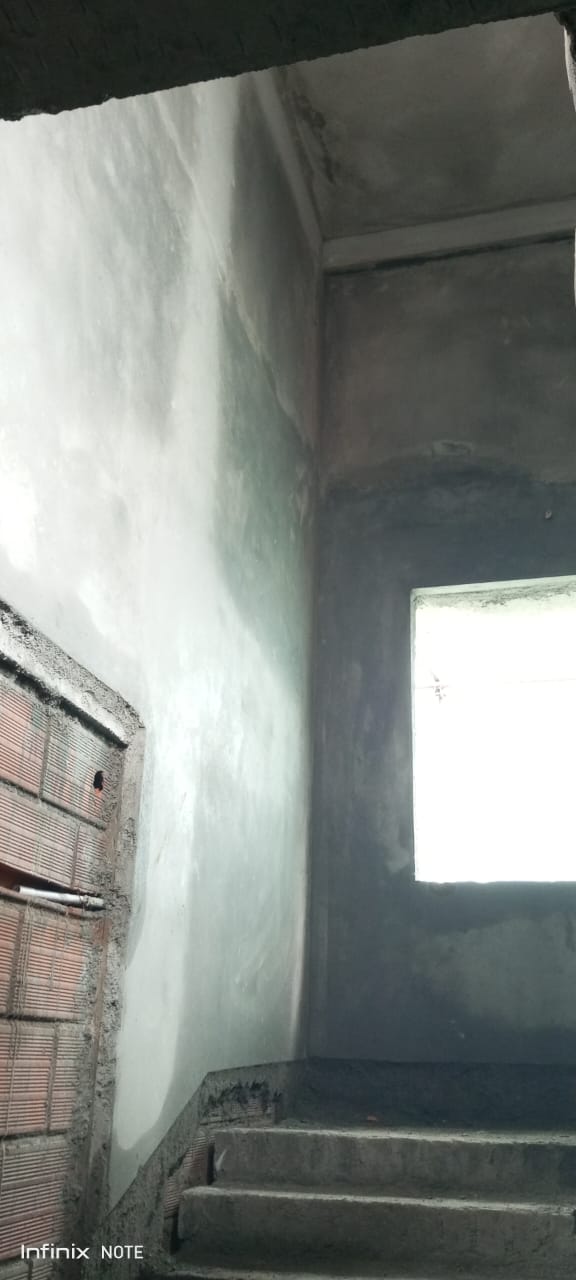

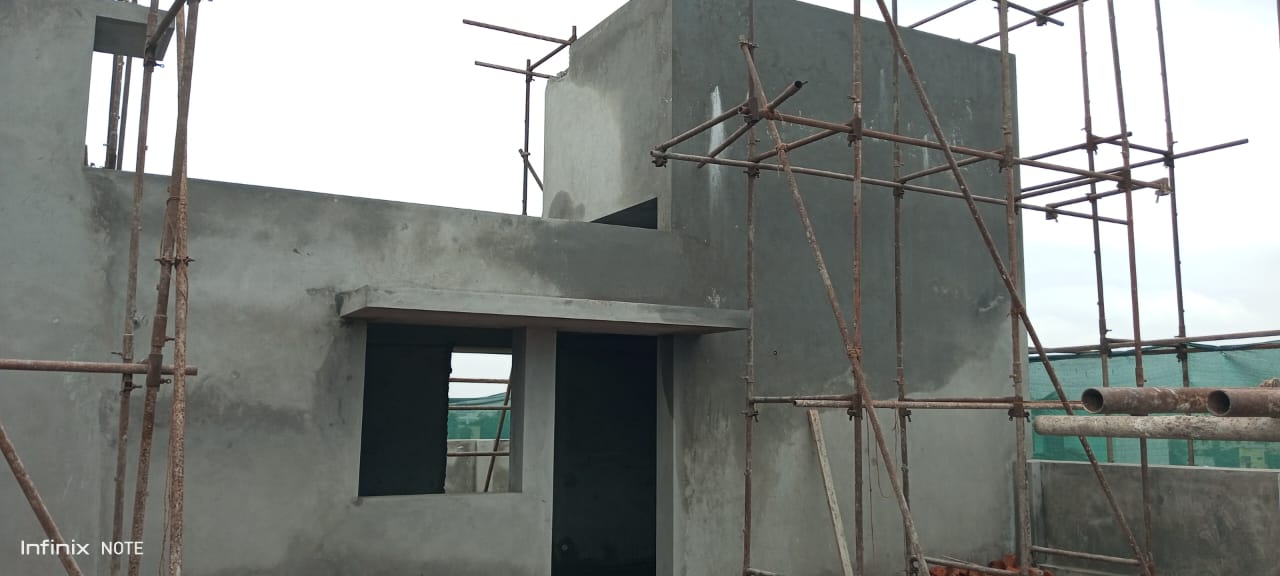

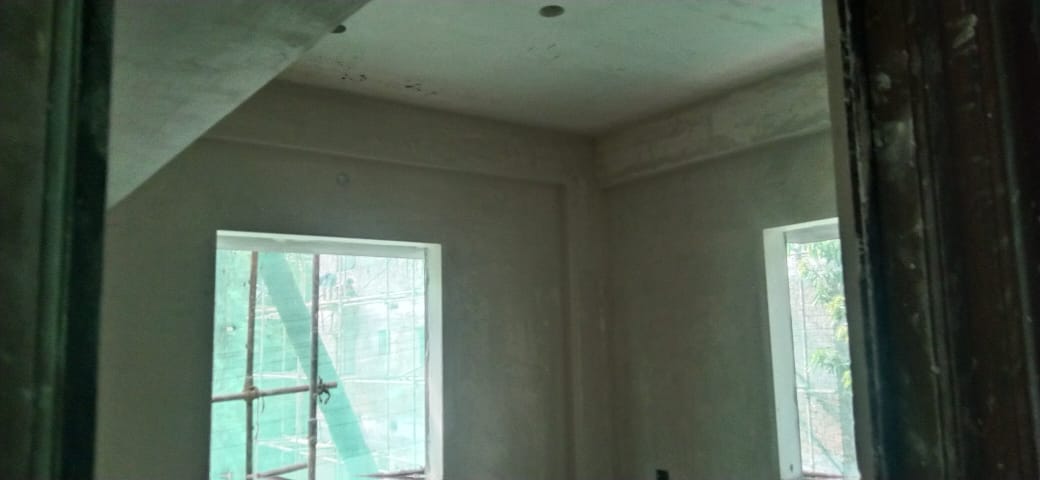

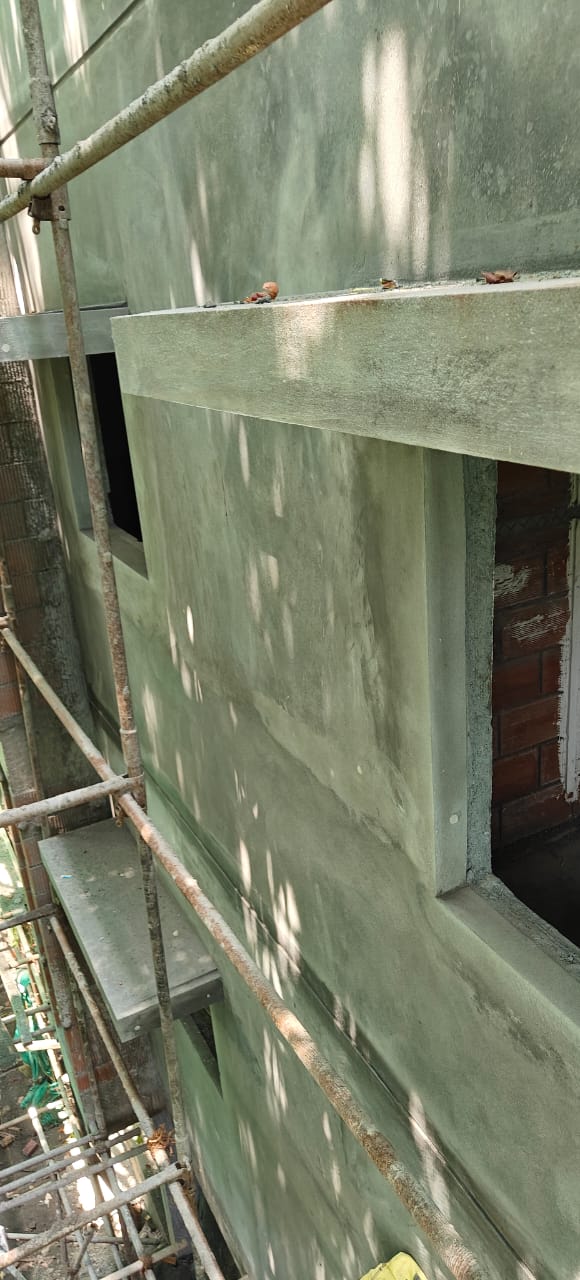

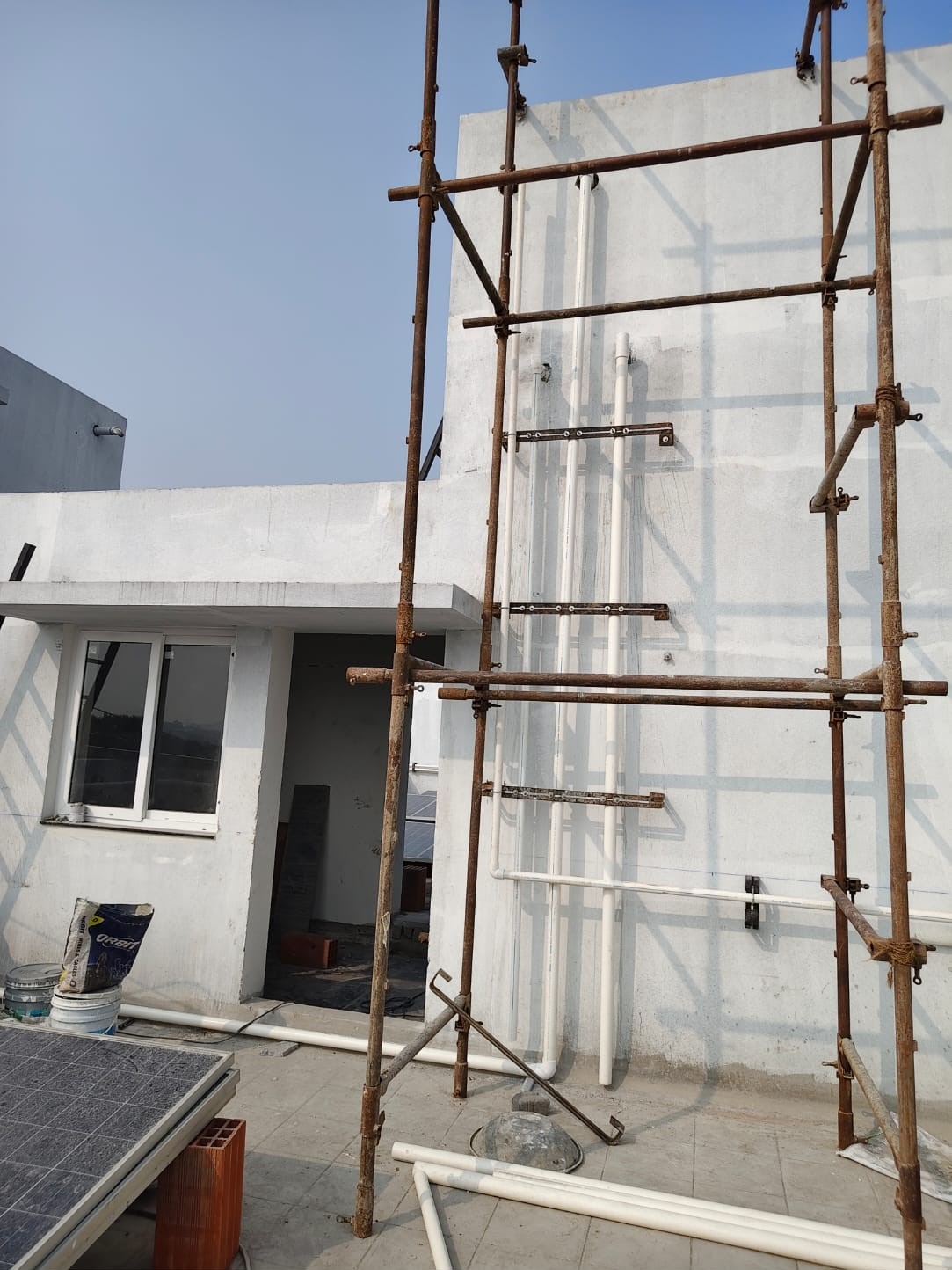

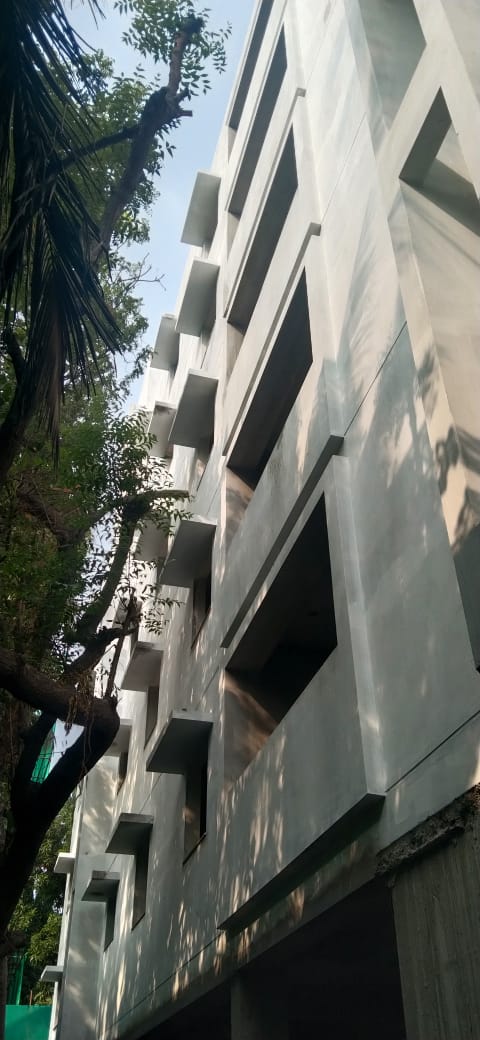

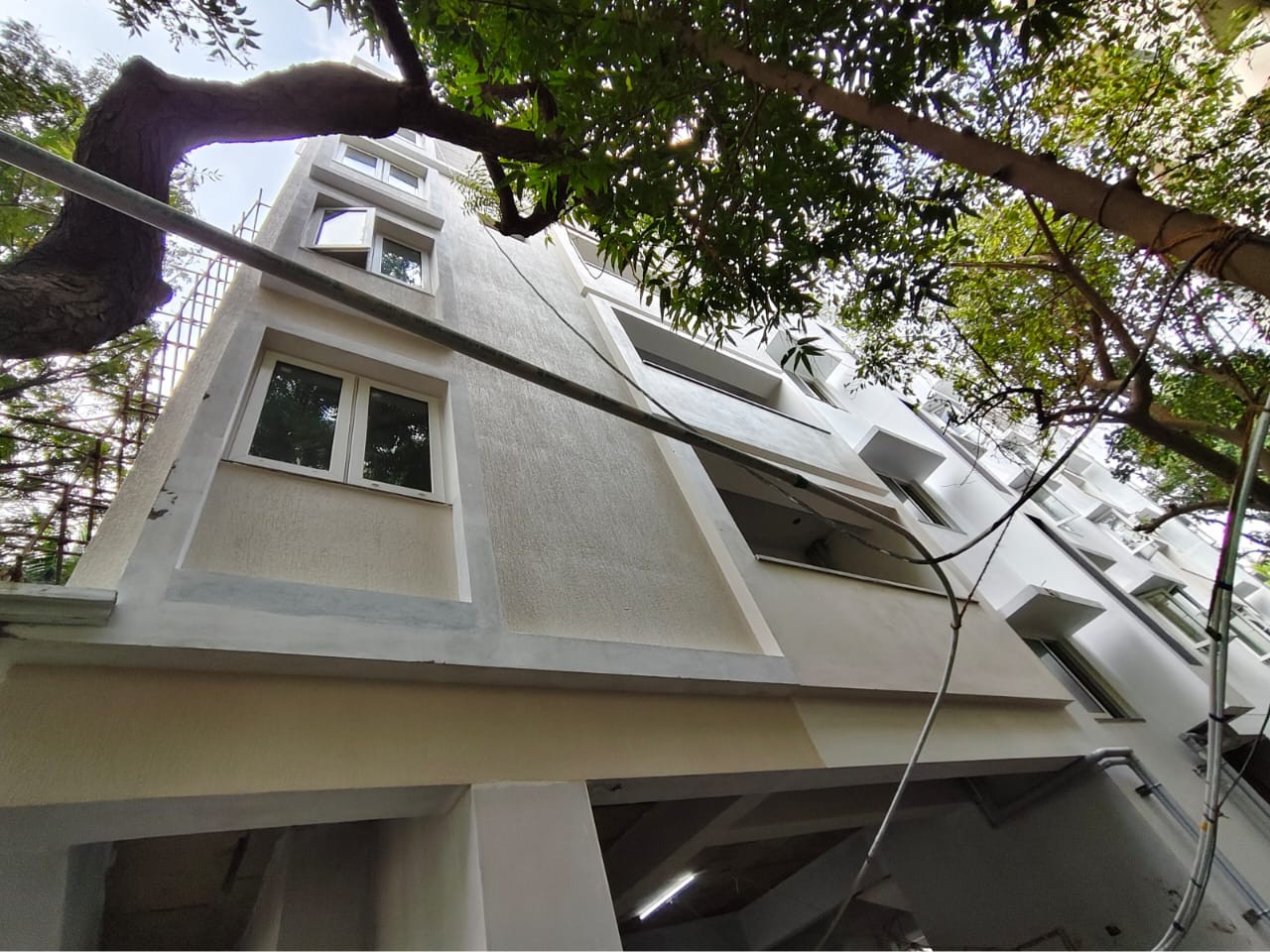

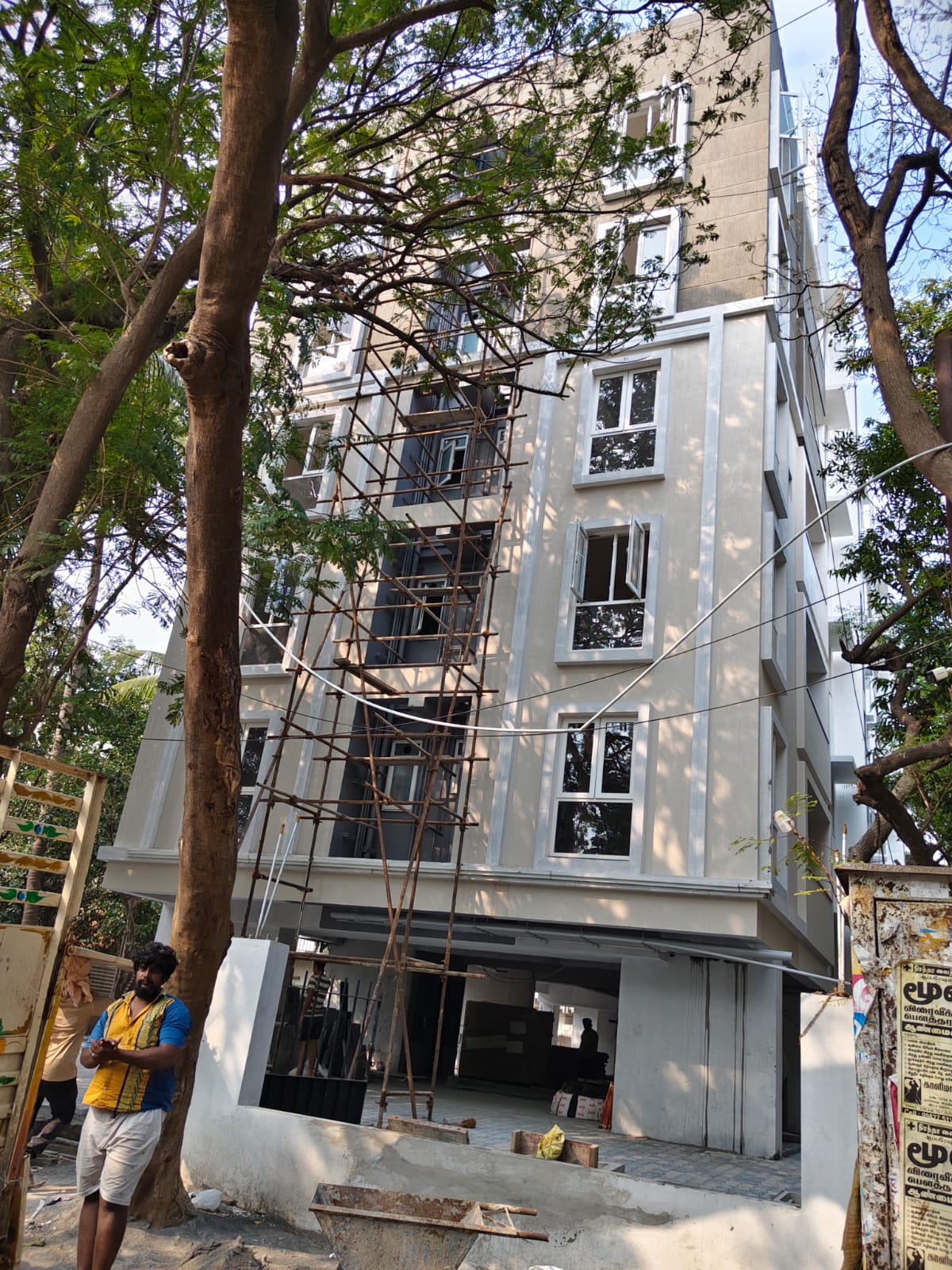

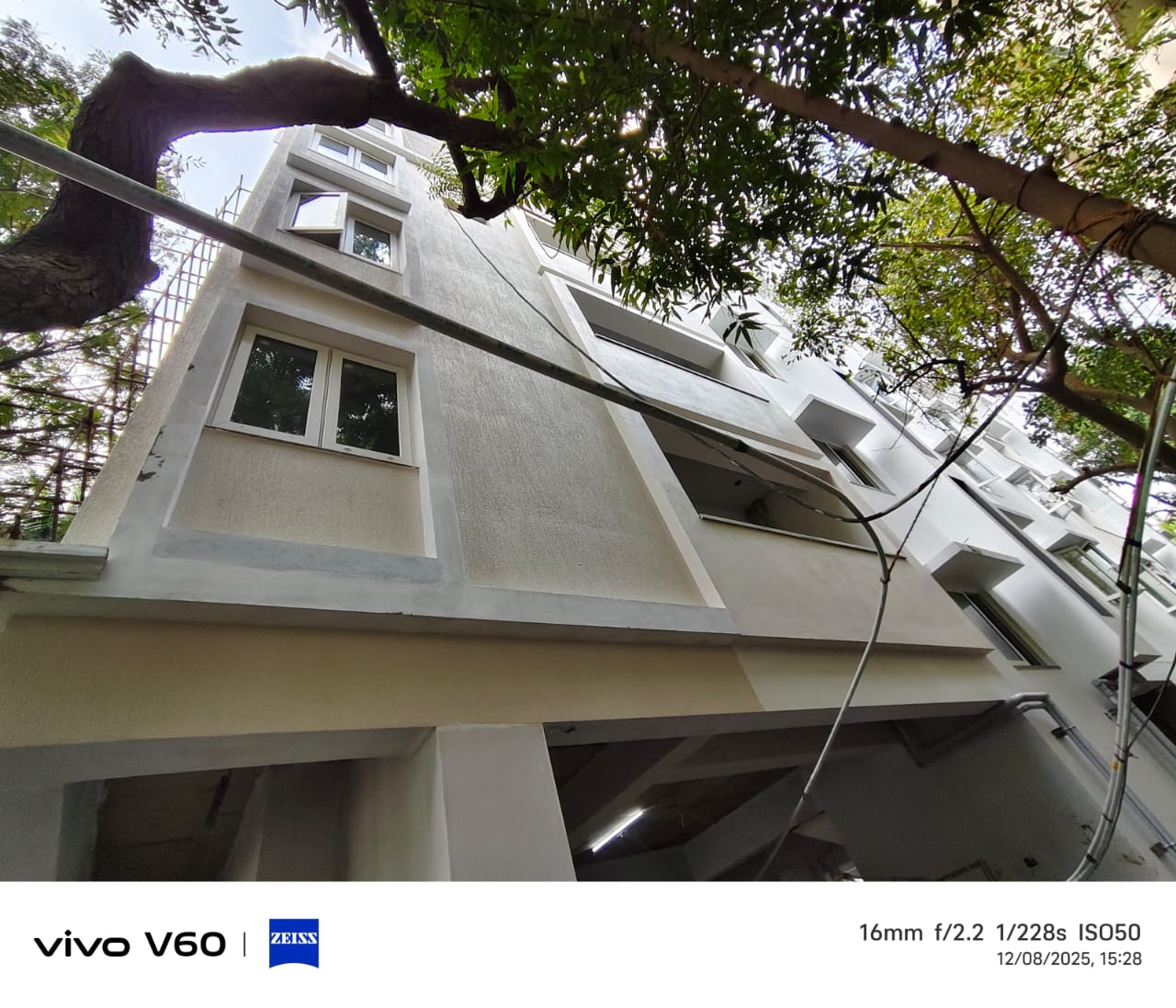

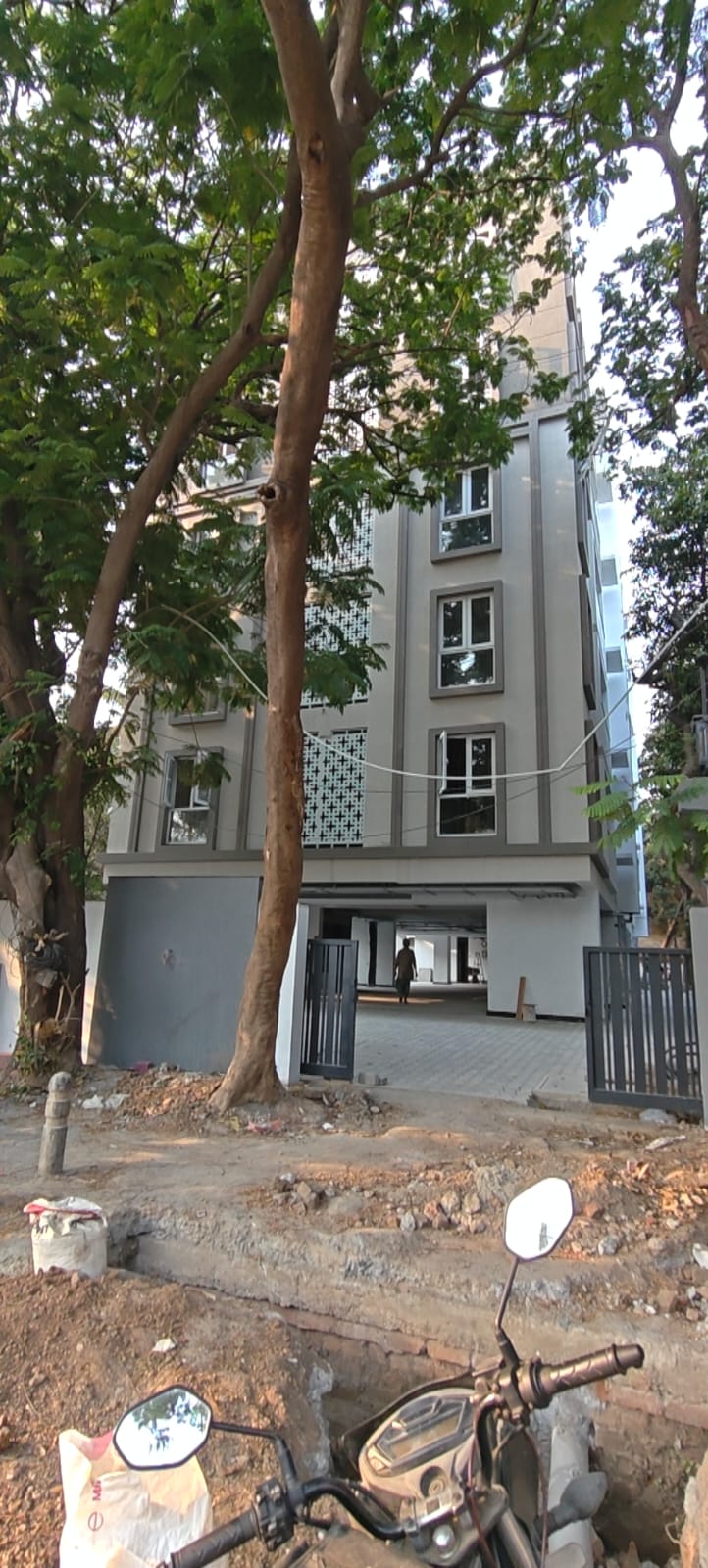

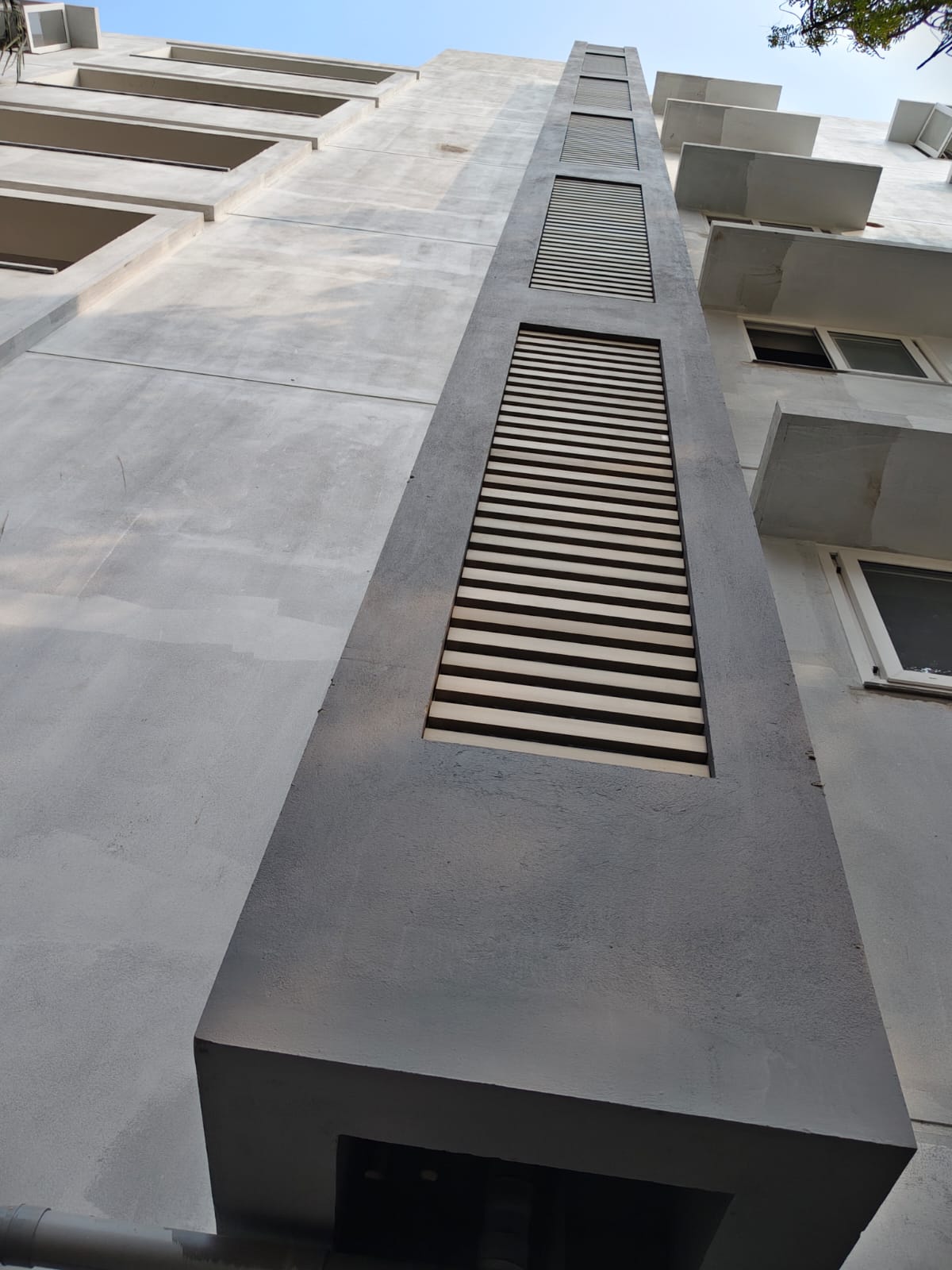

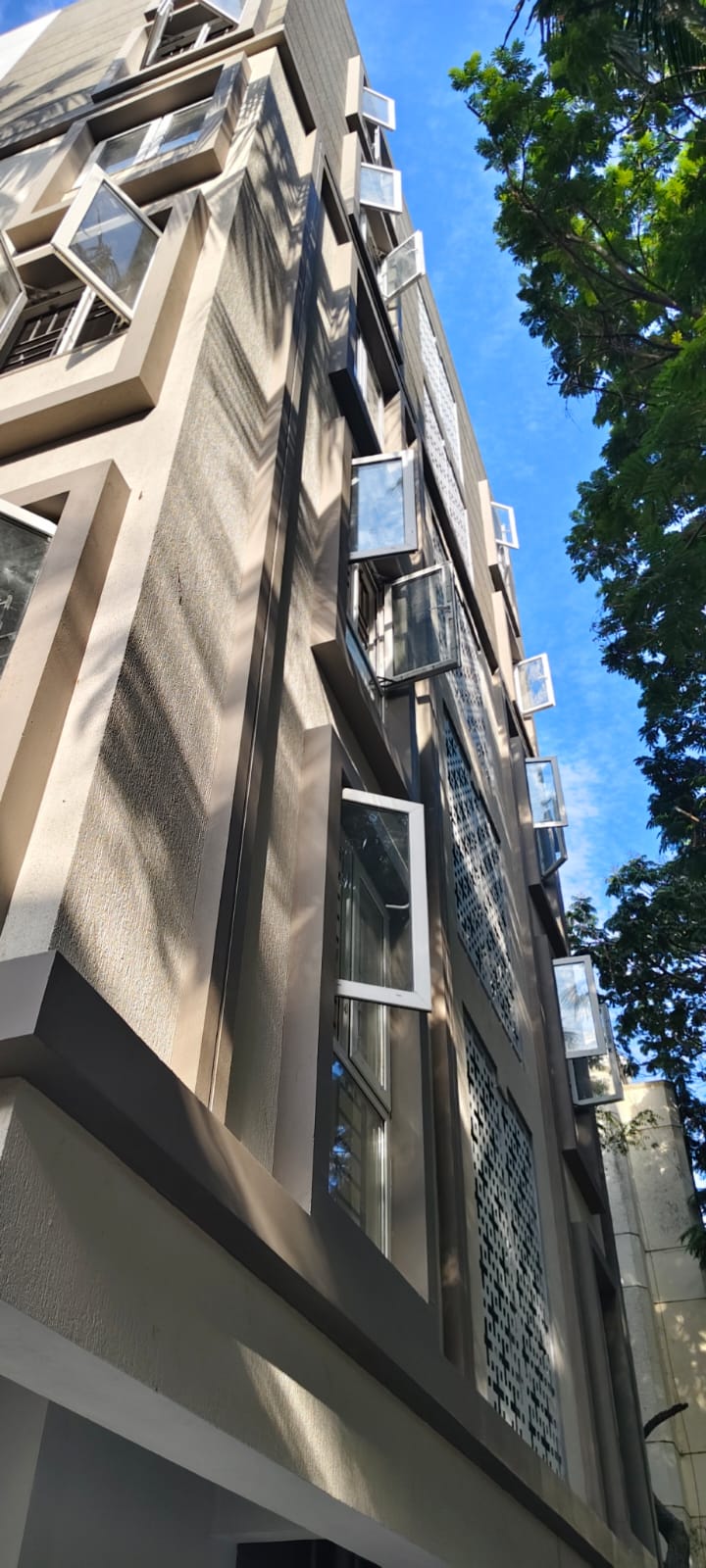

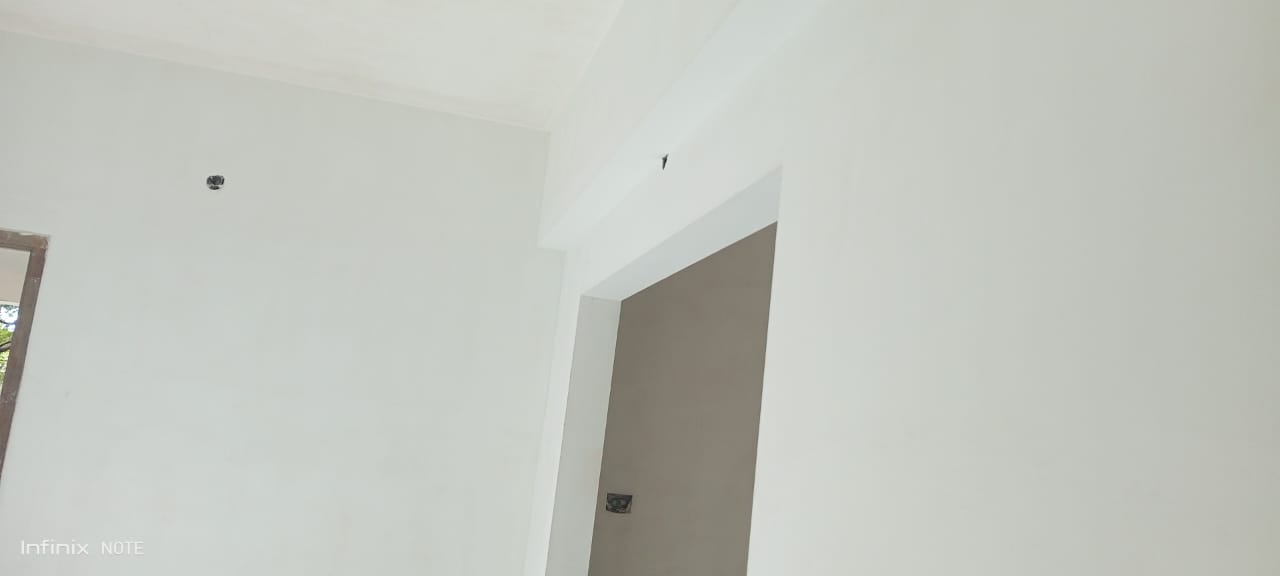

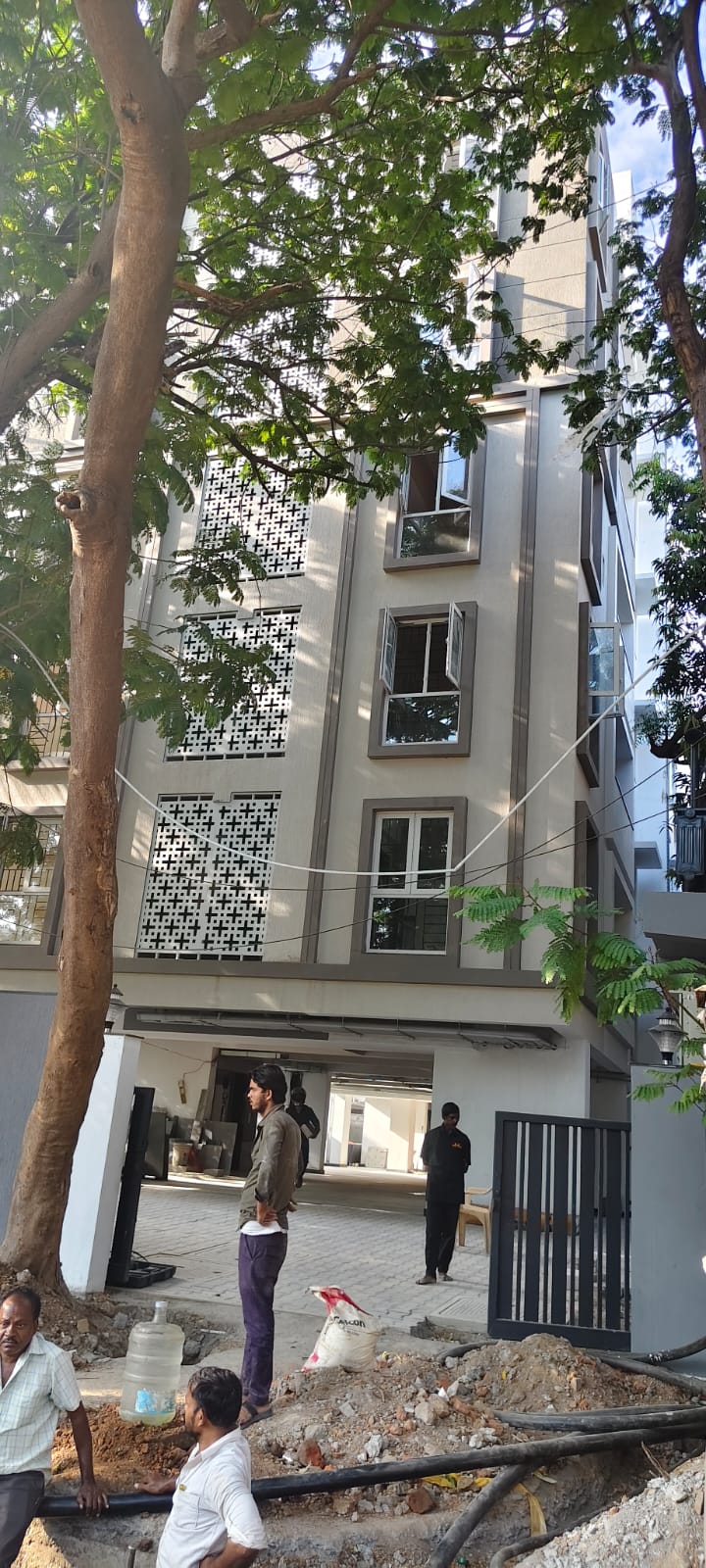

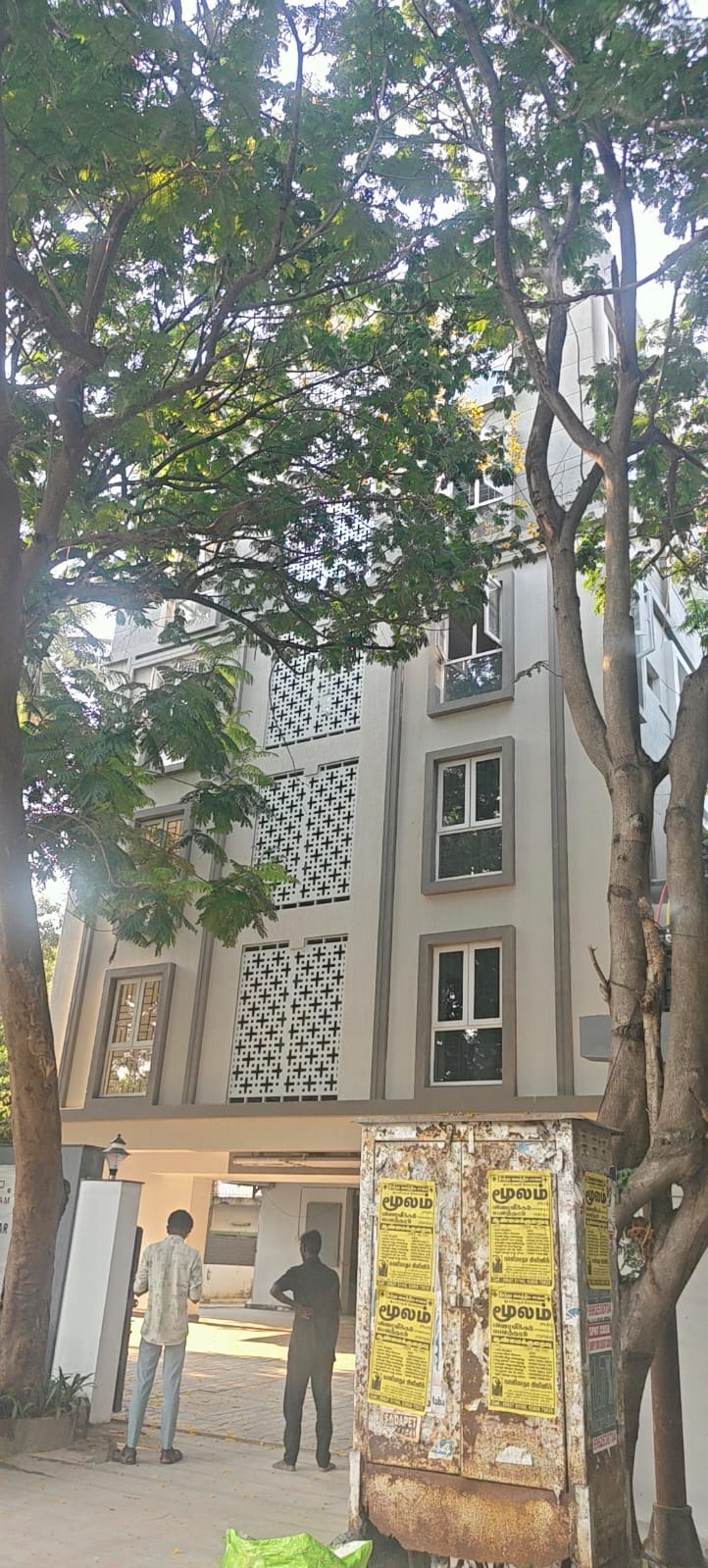

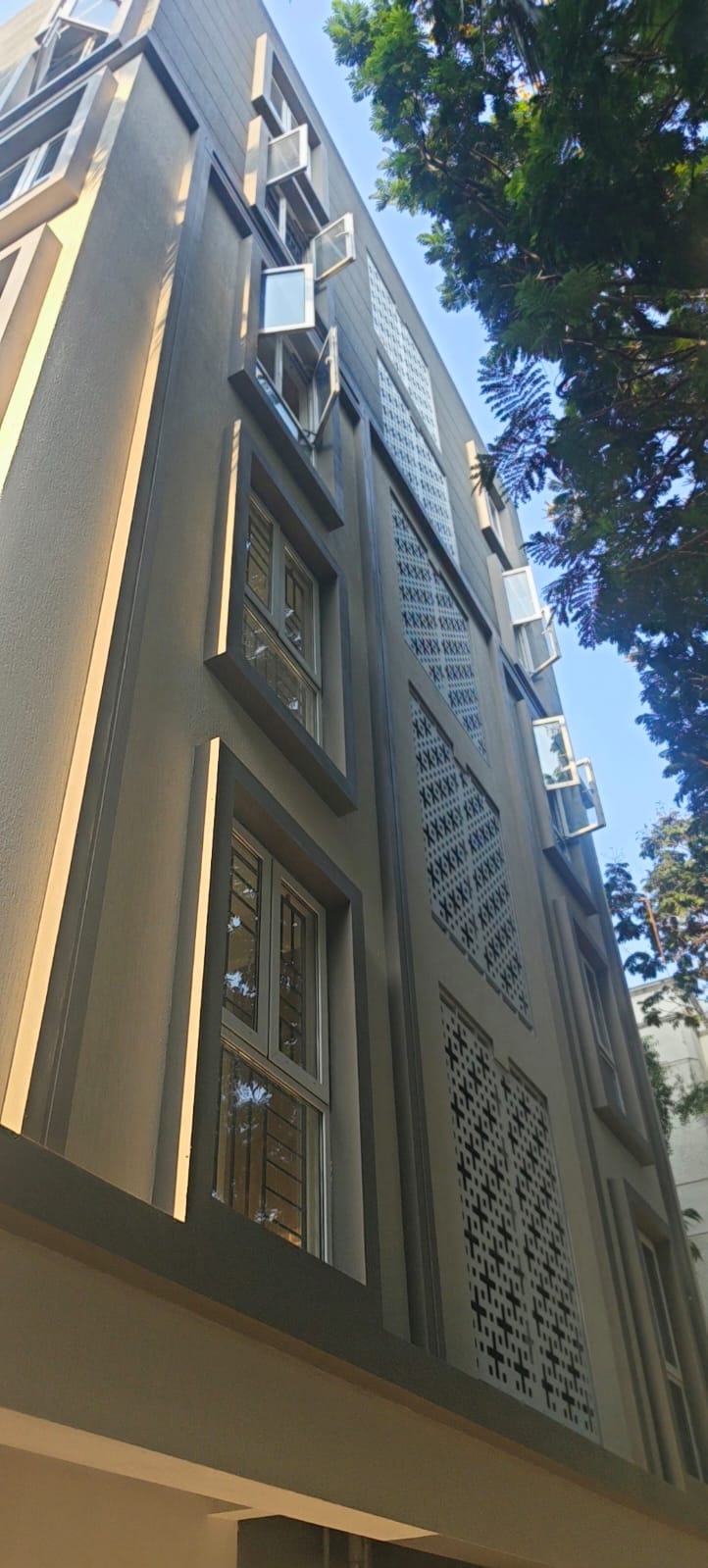

  • External texture painting work is completed.

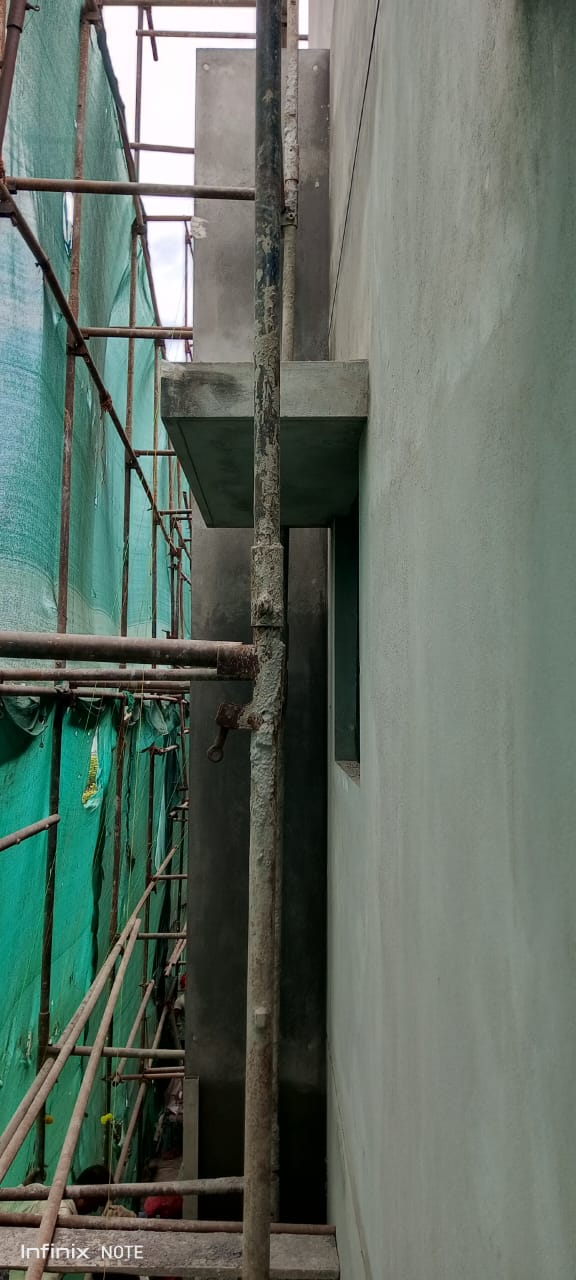

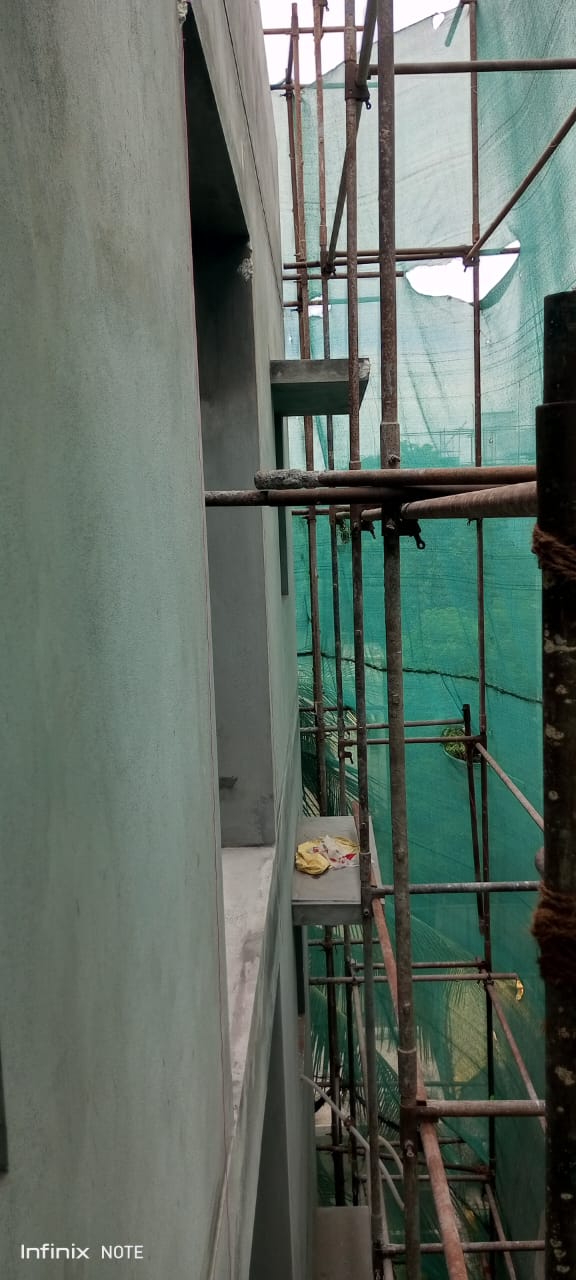

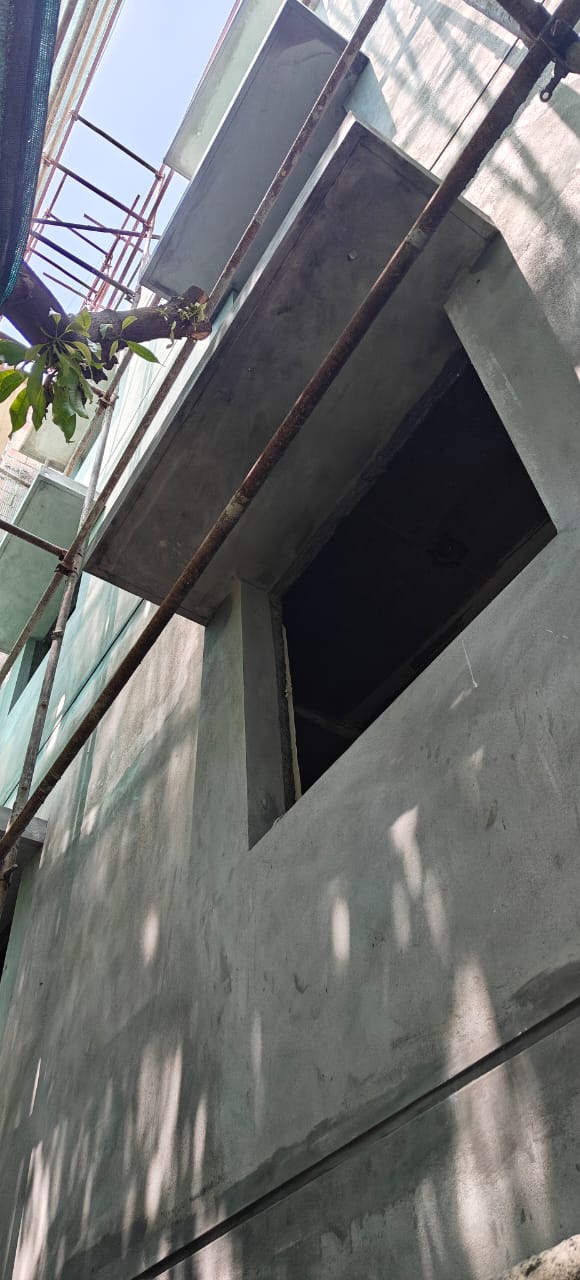

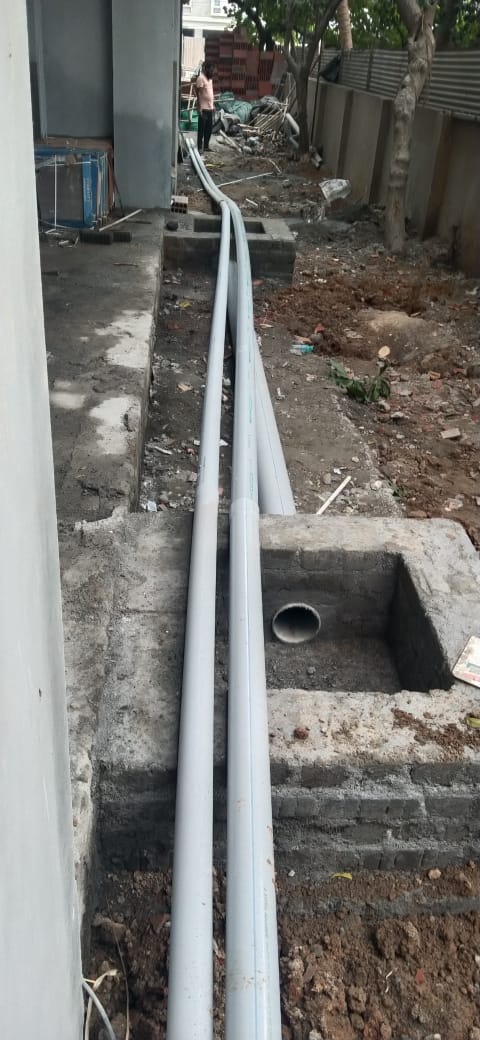

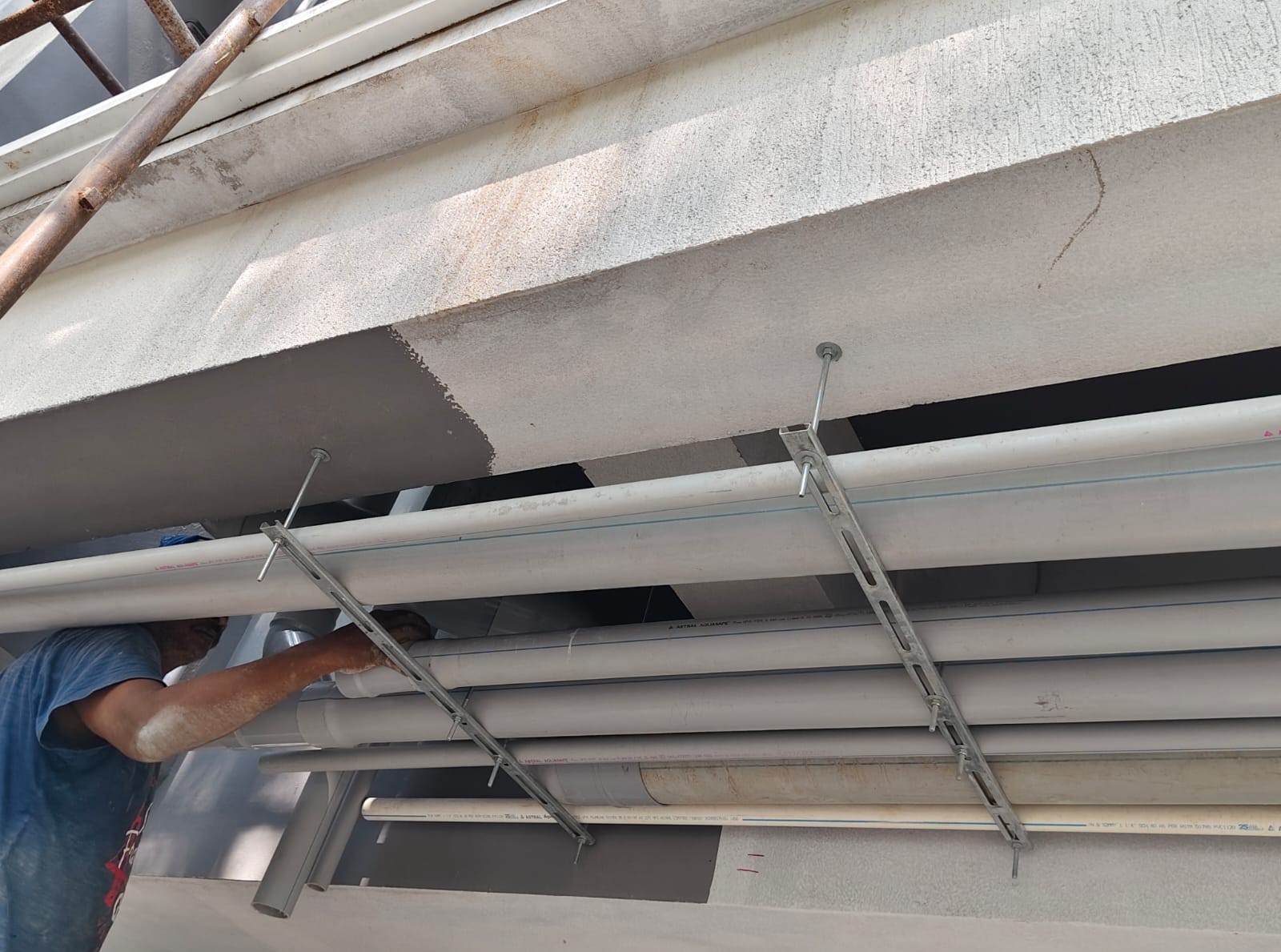

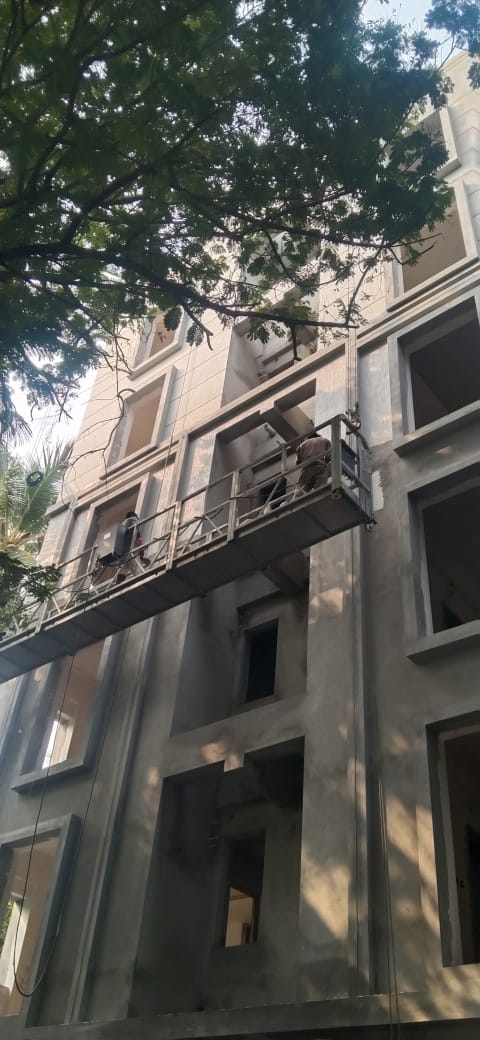

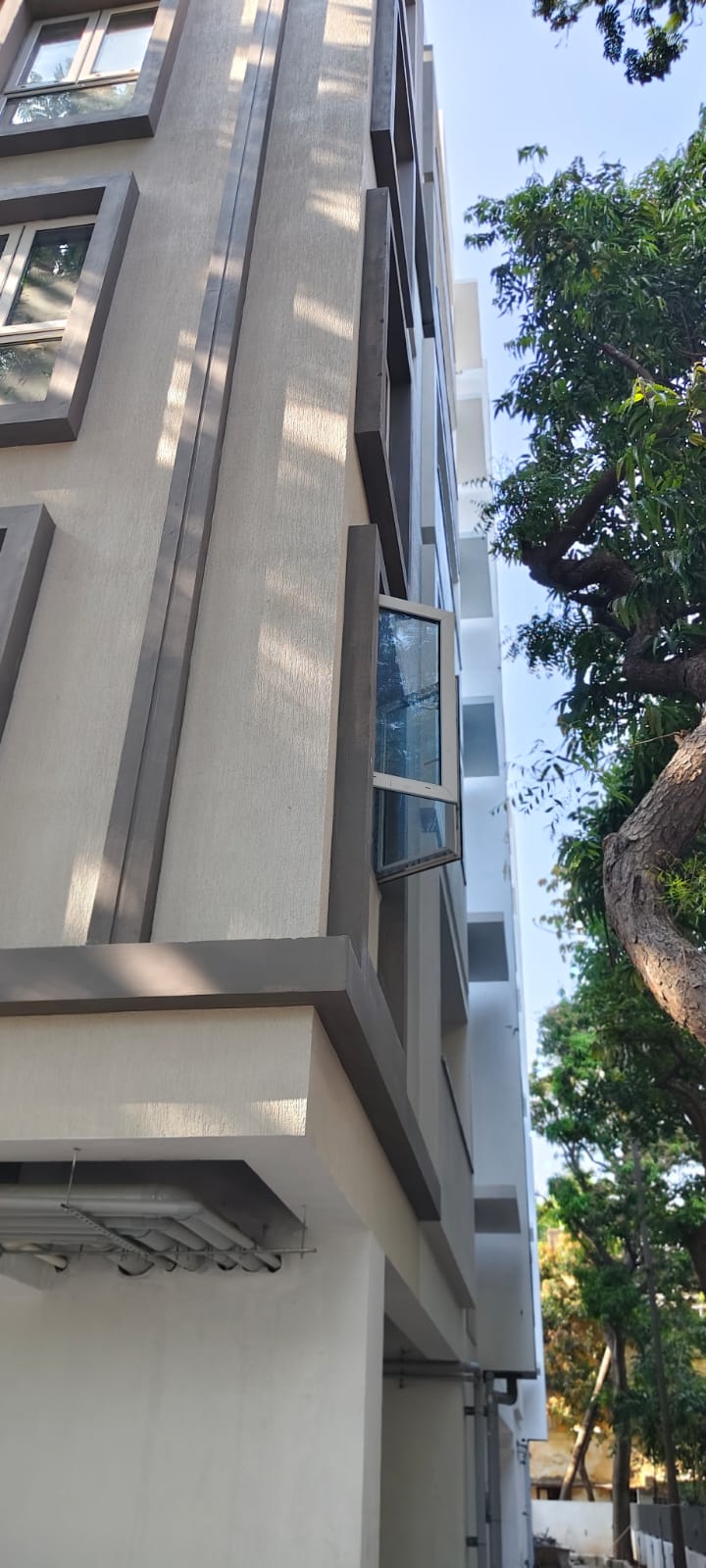

  • External chamber work is in progress. (70% completed)

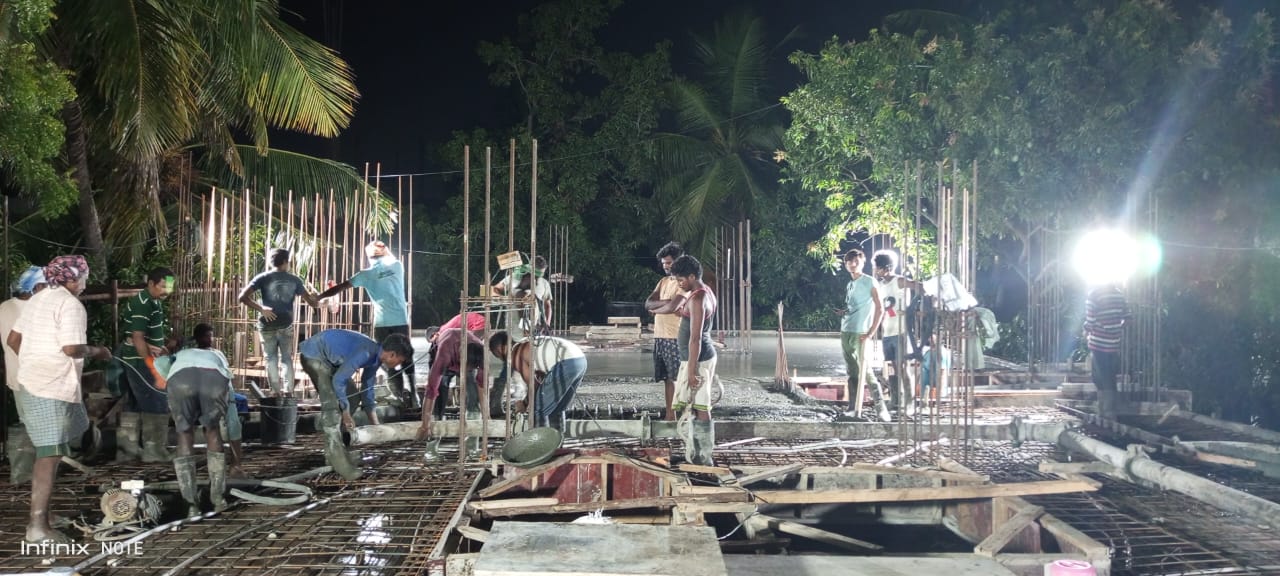

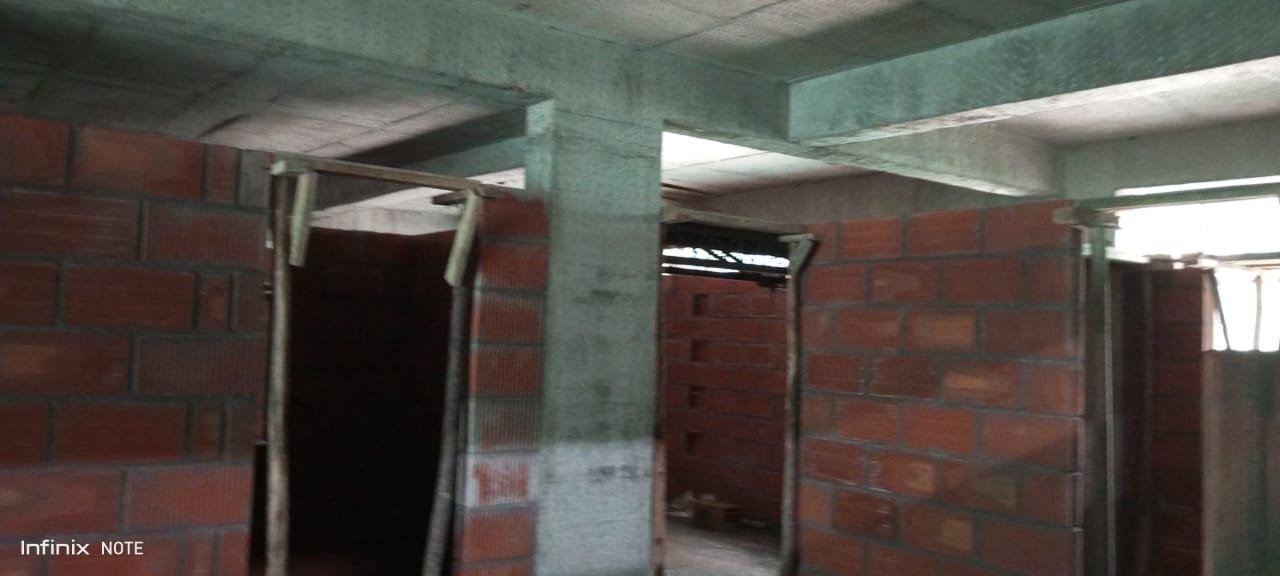

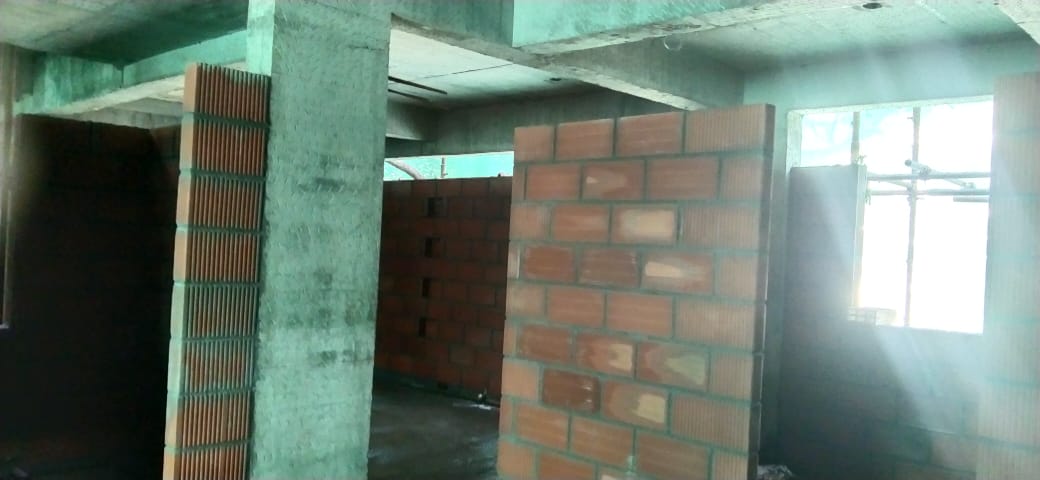

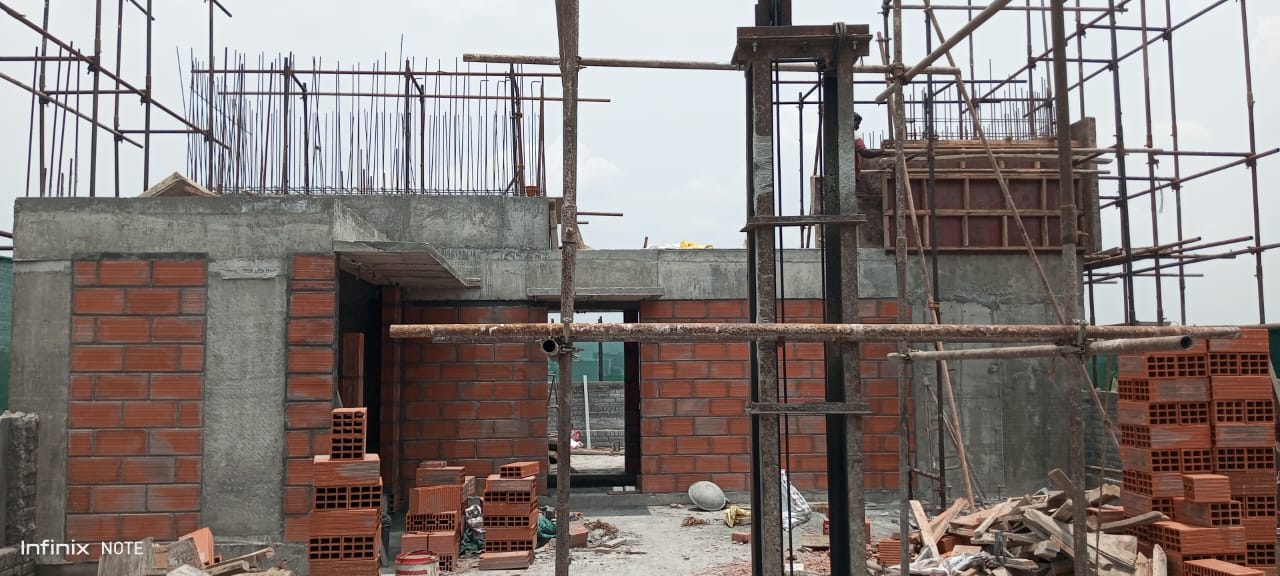

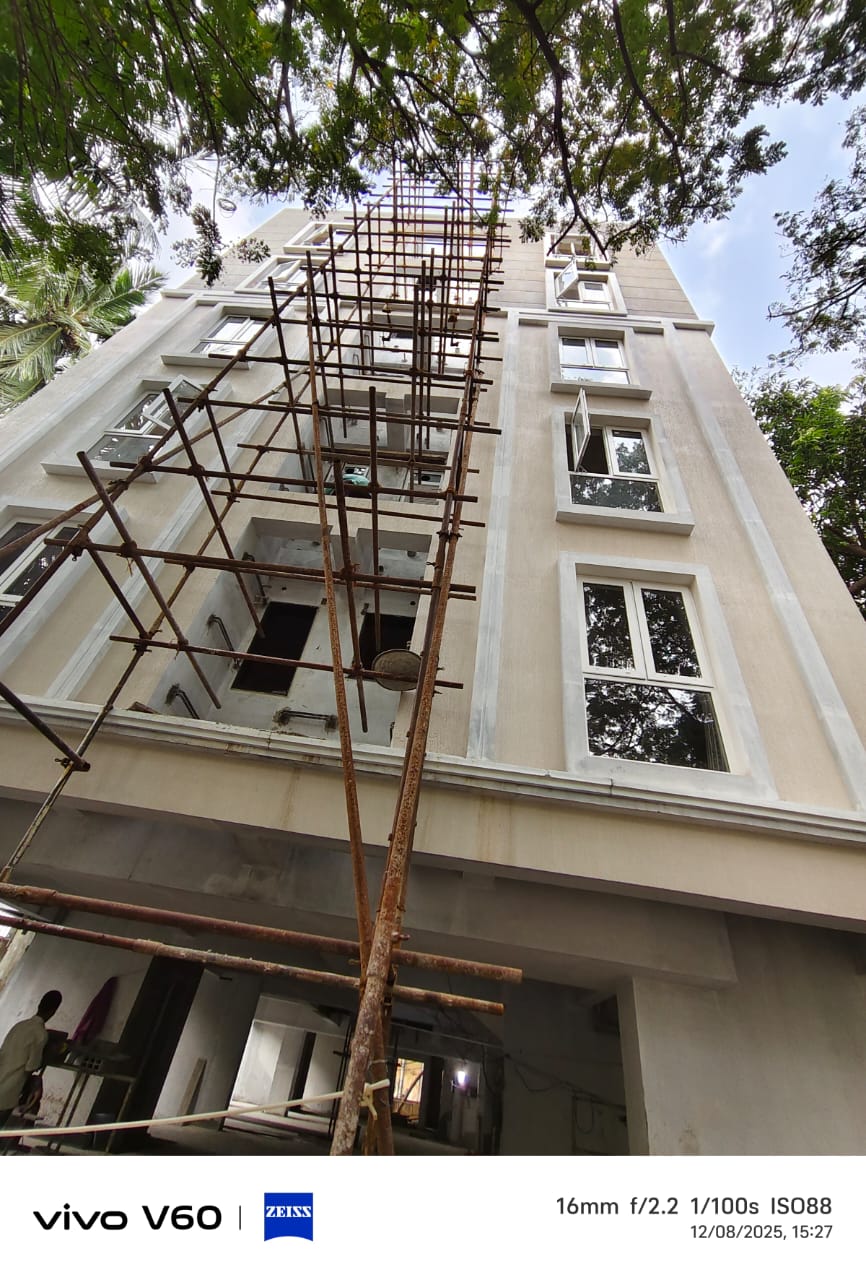

  • Stilt floor column & beam plastering work is completed.

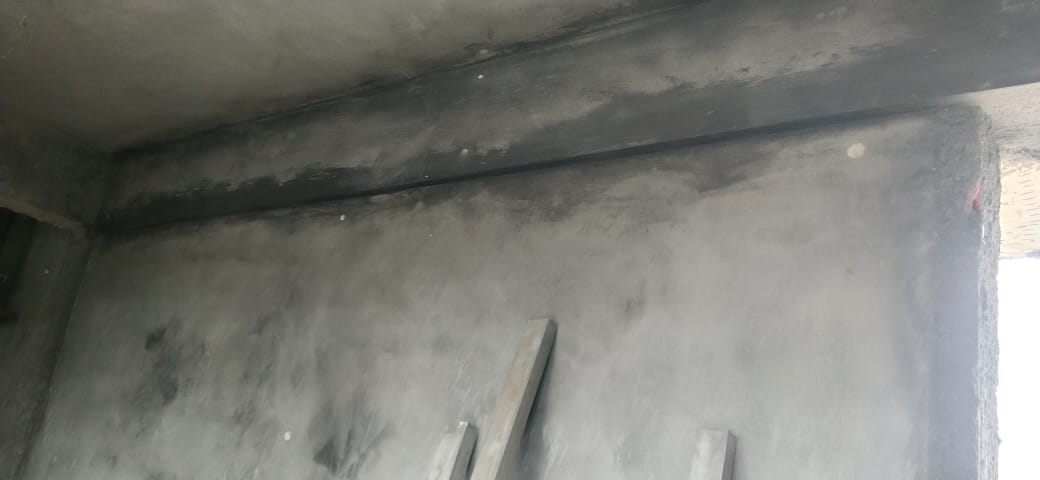

  • 5th floor inner plastering work is completed.
  • Toilet wall tiles work is in progress. (upto 4th floor completed)
  • 4thfloor general flooring work is in progress. (upto 3rd floor completed)
  • Compound wall work is in progress.(south side progress)

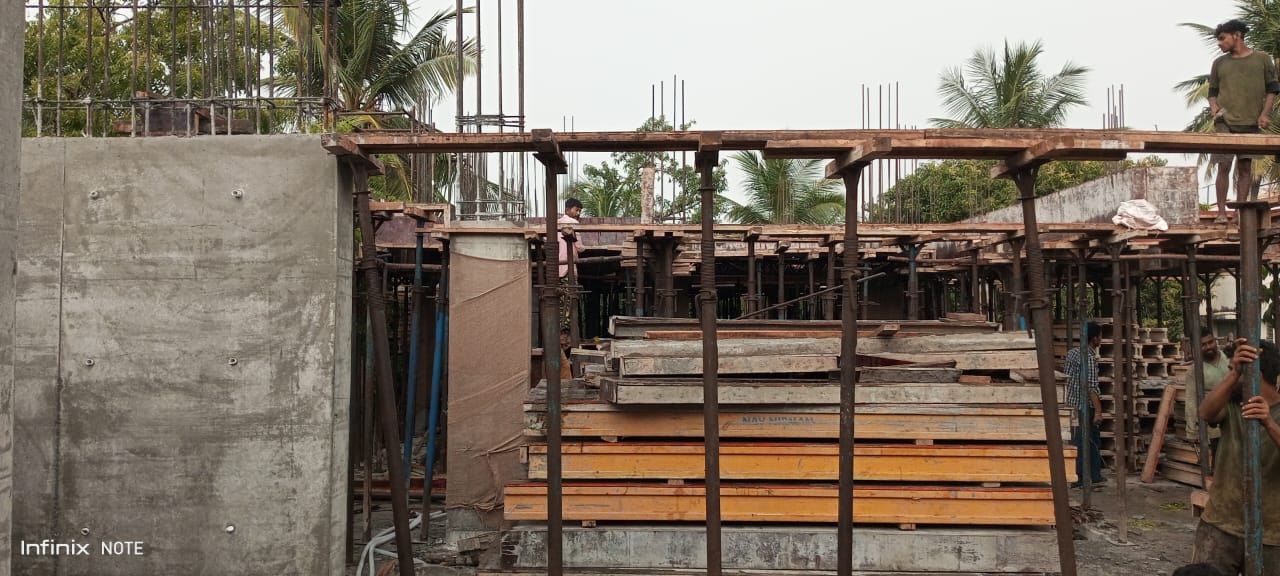

  • External chamber work is in progress. (75% completed)

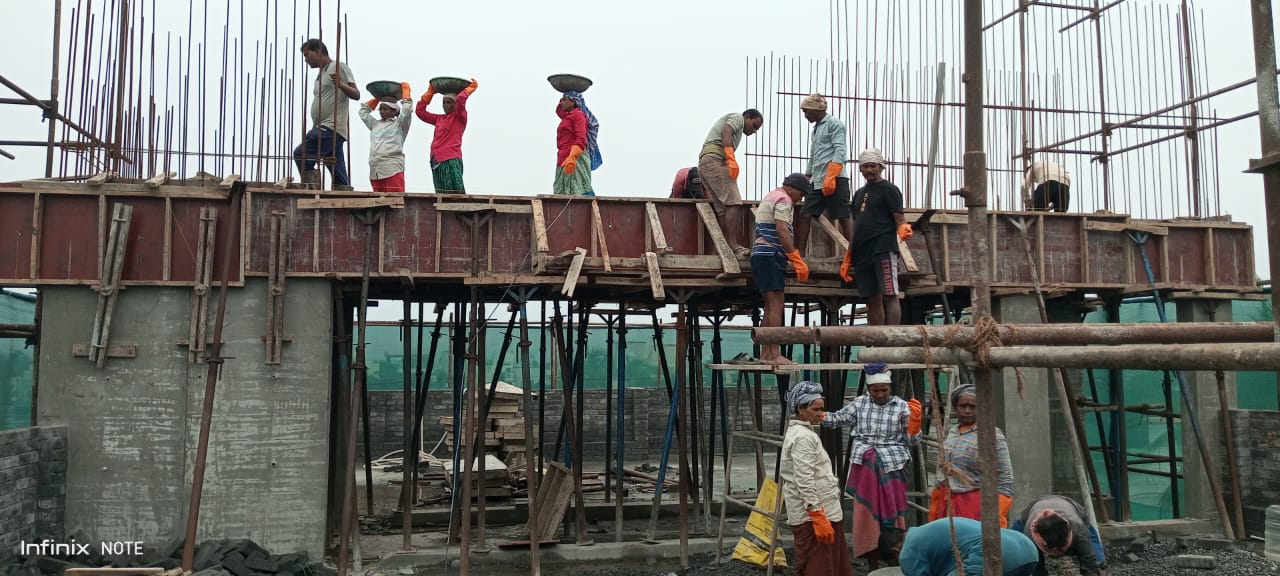

  • 5th floor inner plastering work is completed.

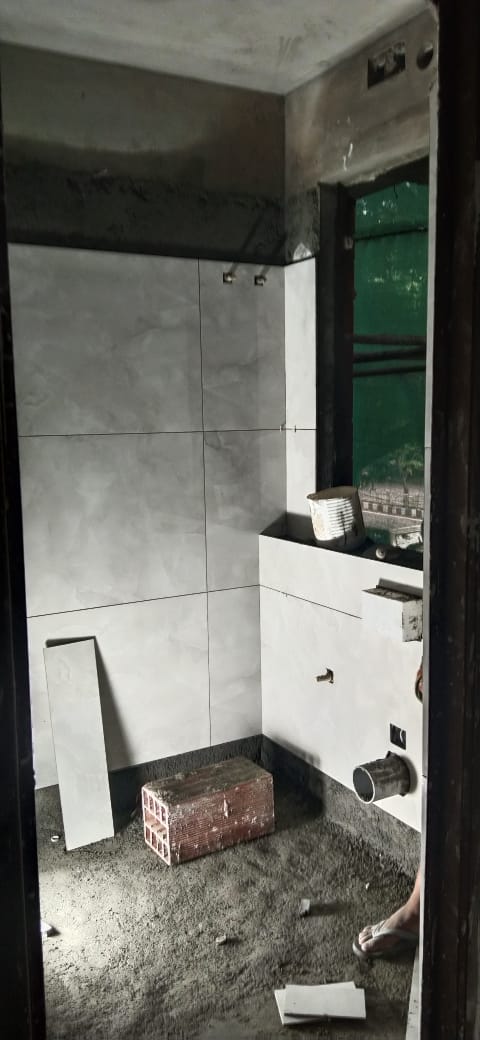

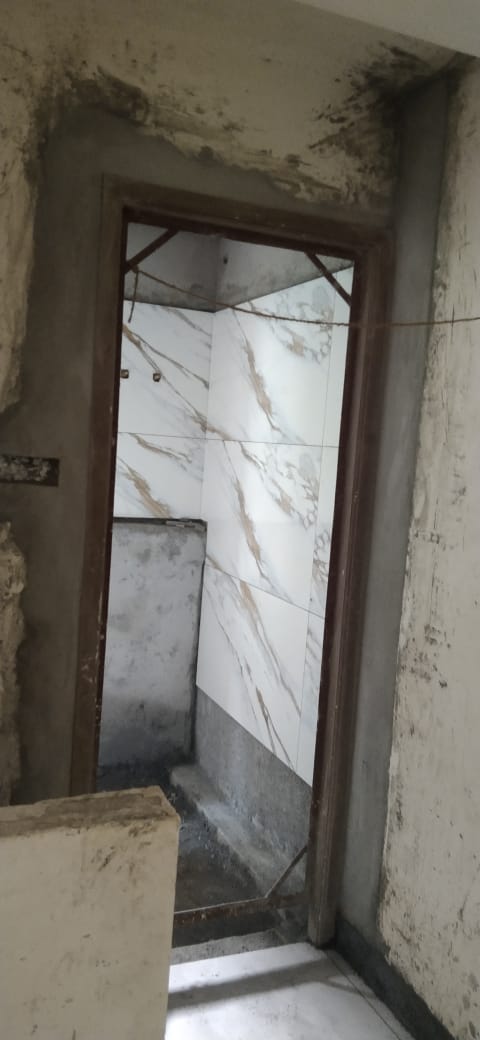

  • 5th floor toilet wall tiles work is in progress. (upto 4th floor completed)

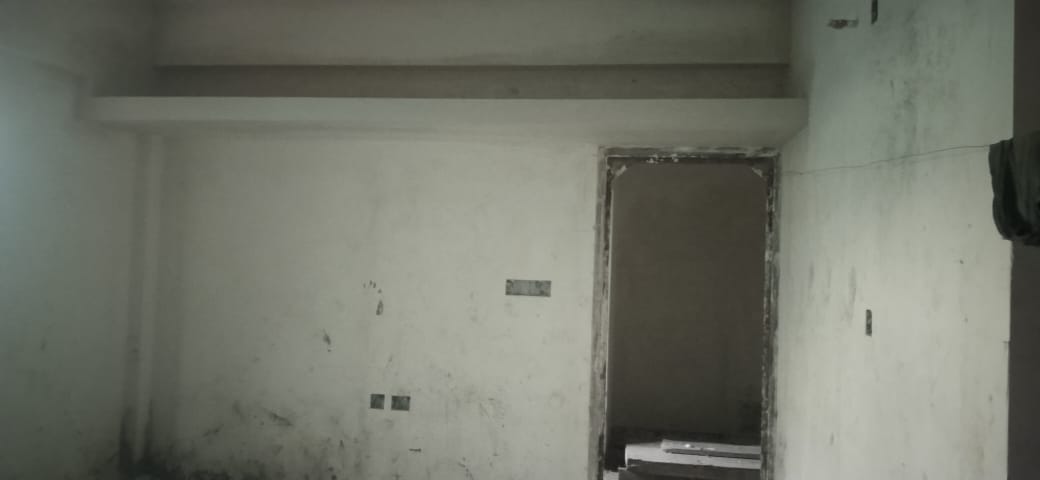

  • 5thfloor general flooring work is in progress. (upto4th floor completed)

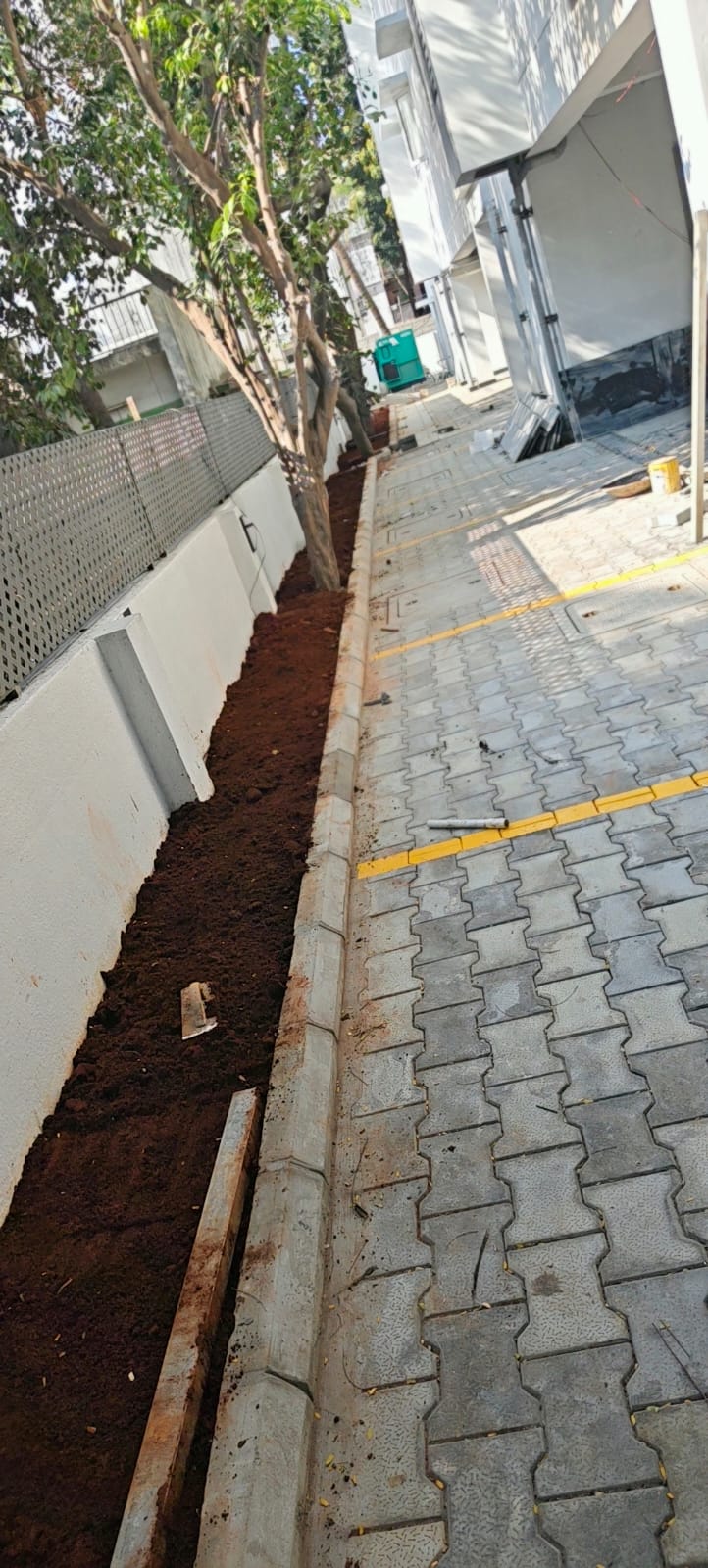

  • Compound wall work is in progress.(south side progress)

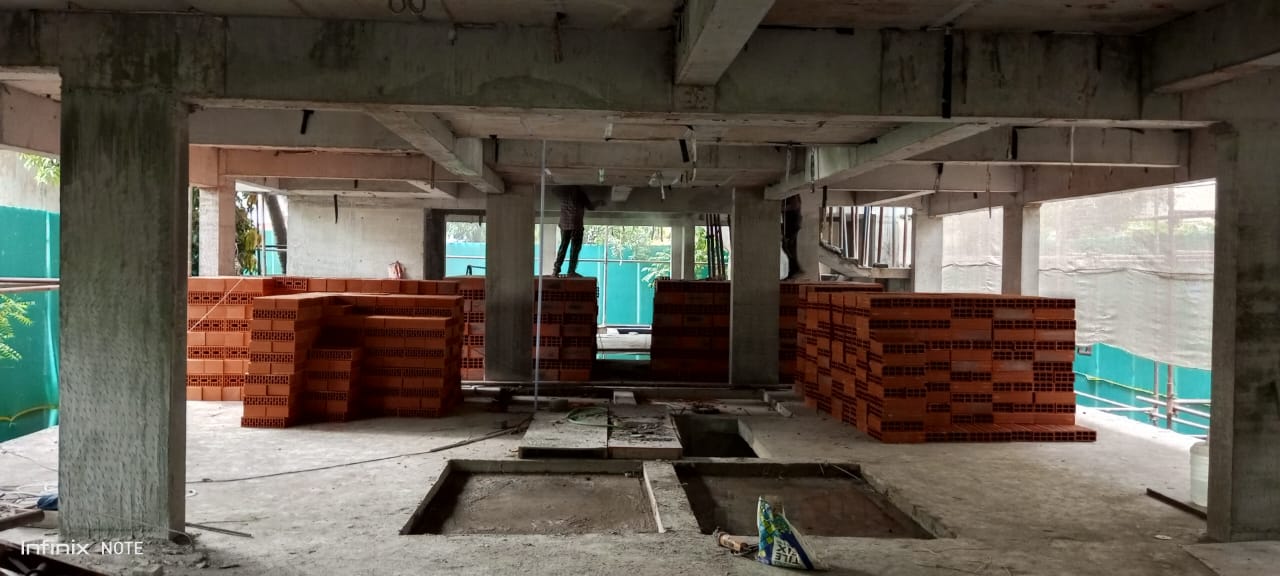

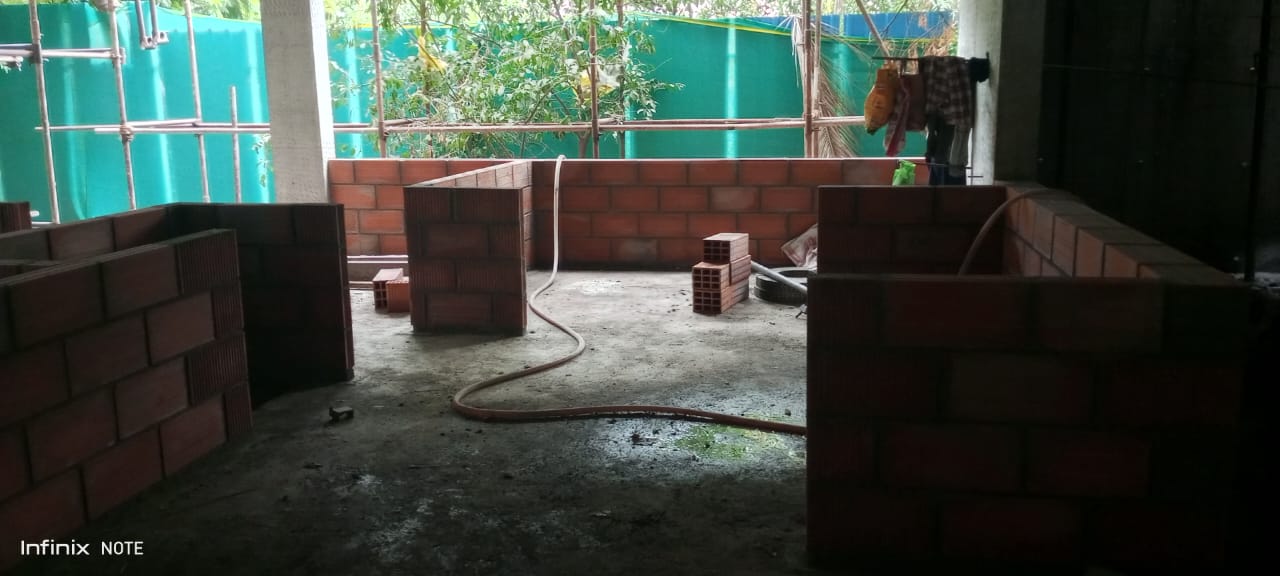

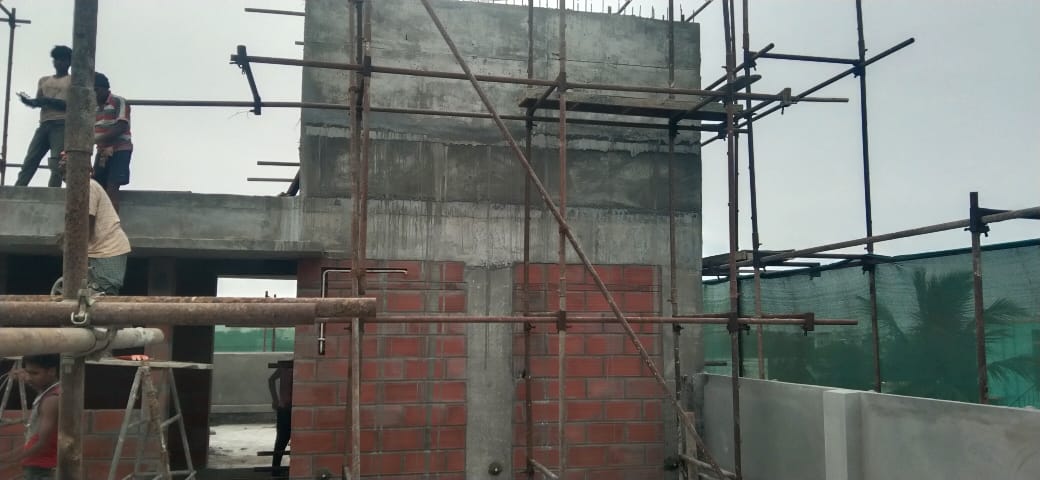

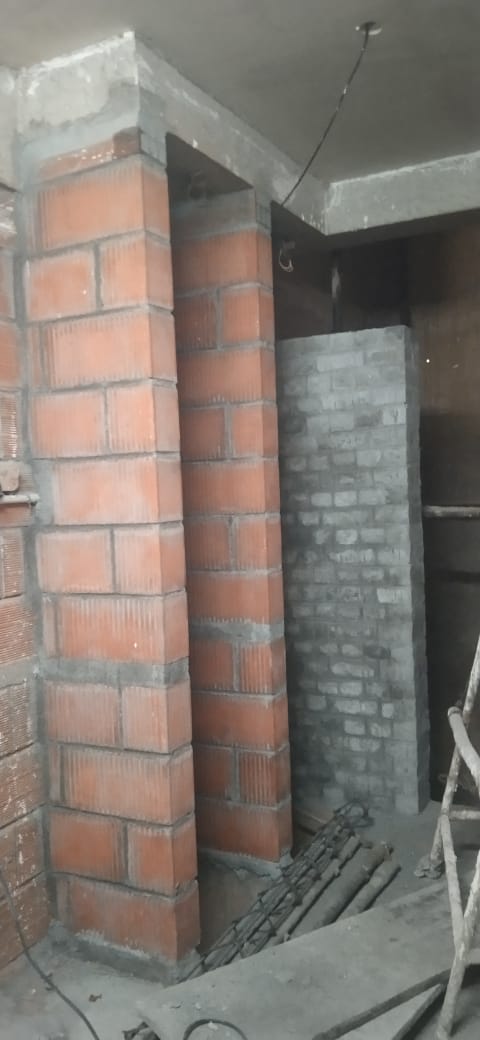

  • External chamber work is completed.

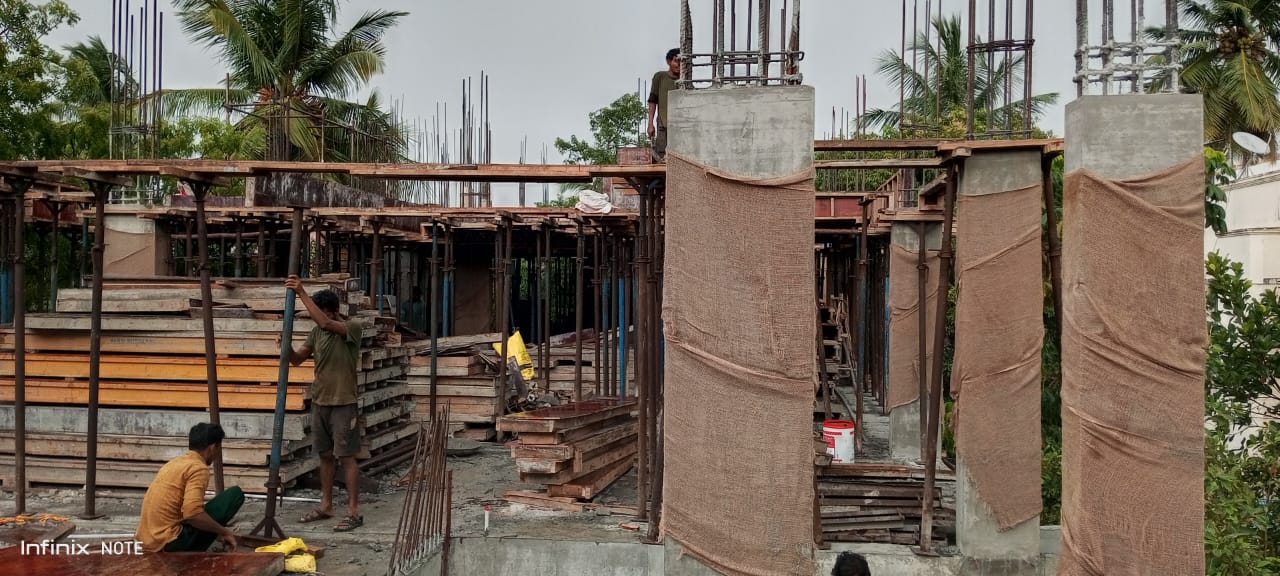

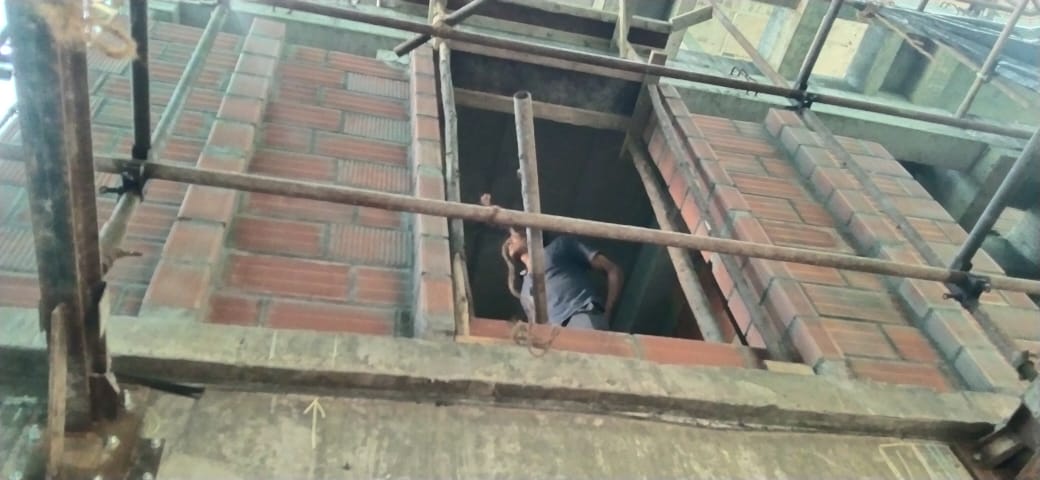

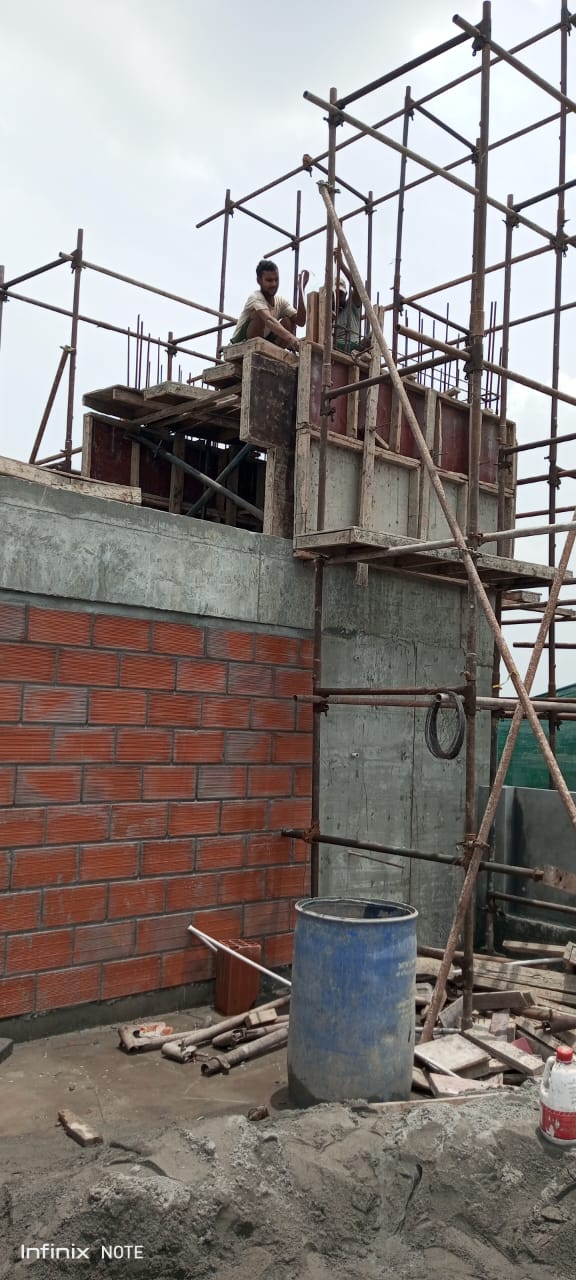

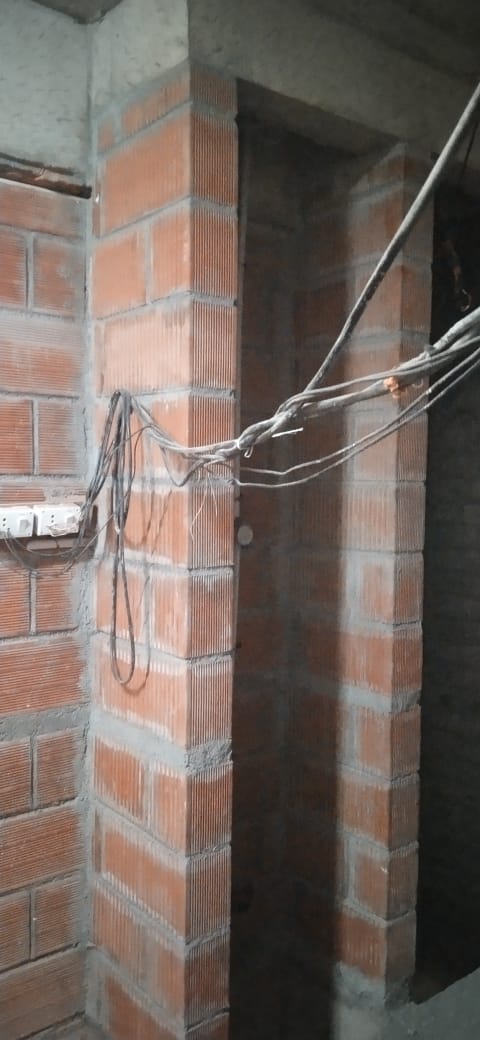

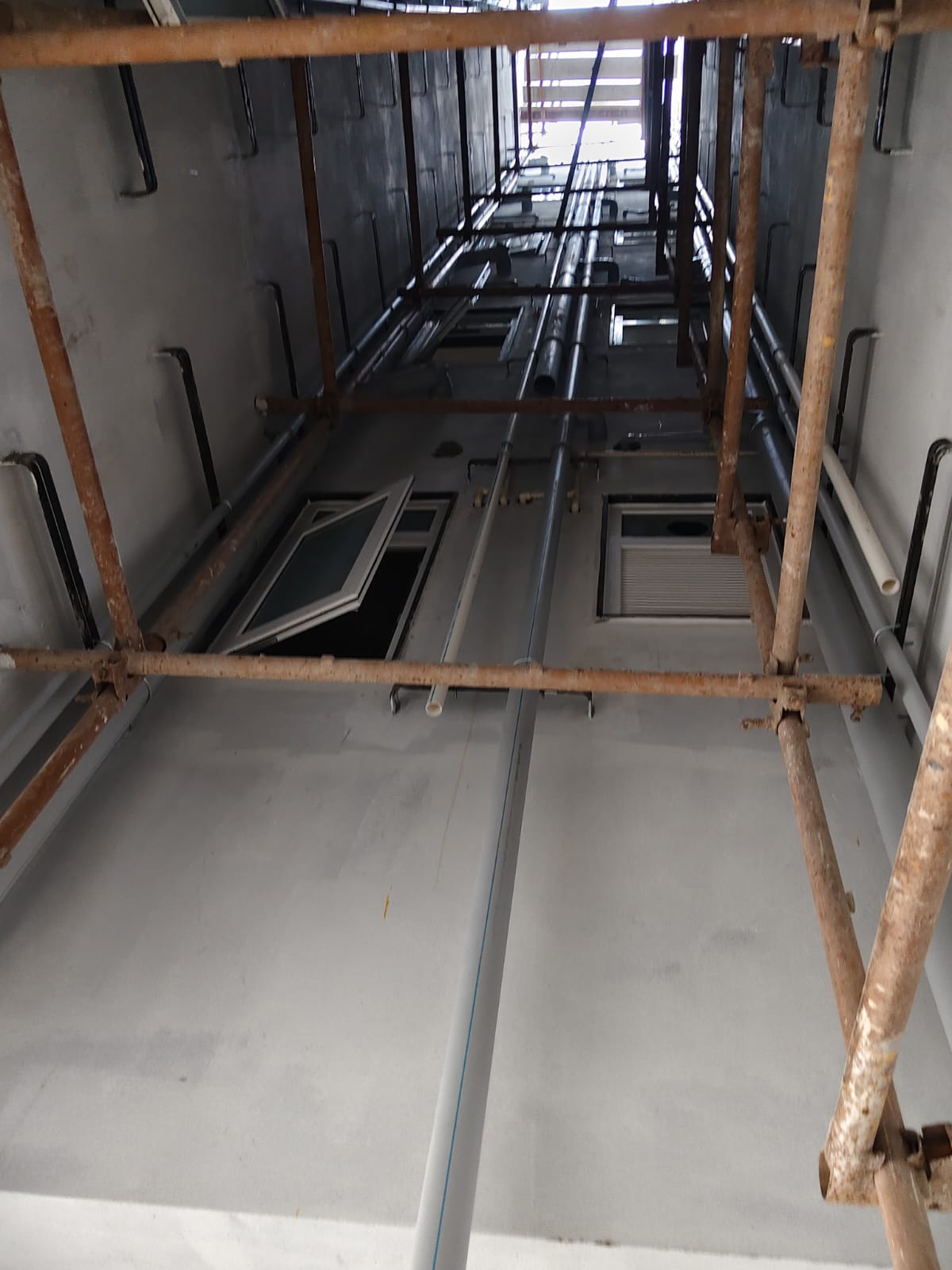

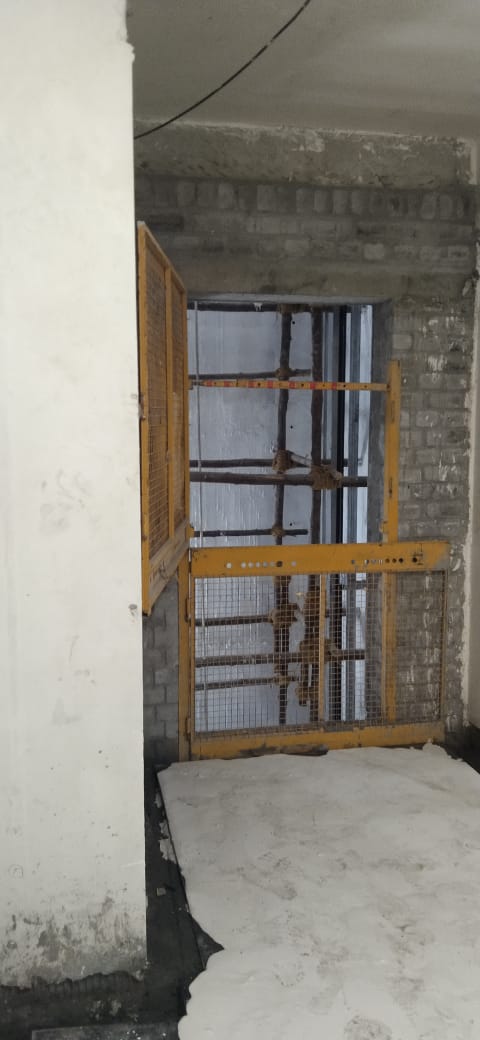

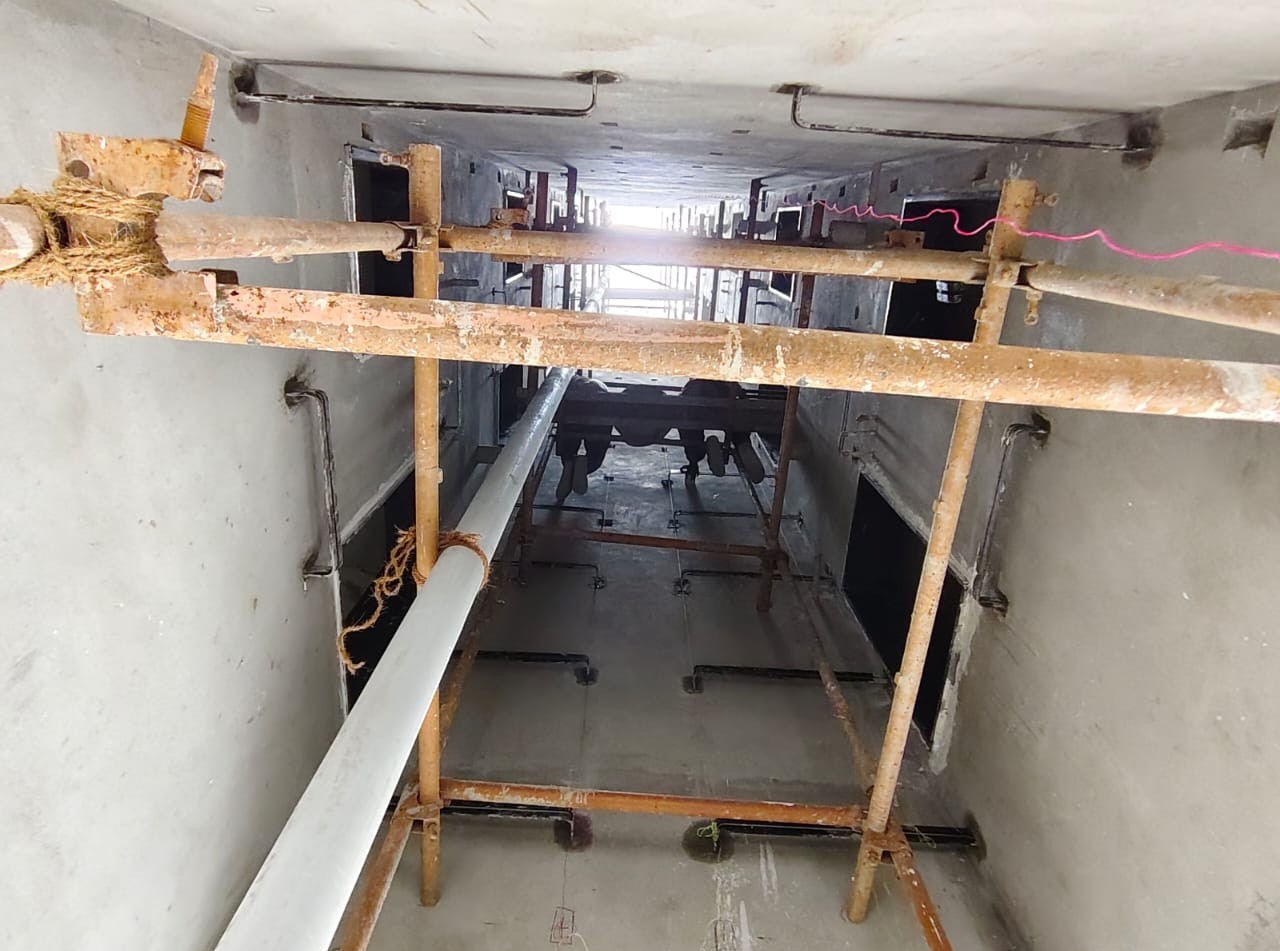

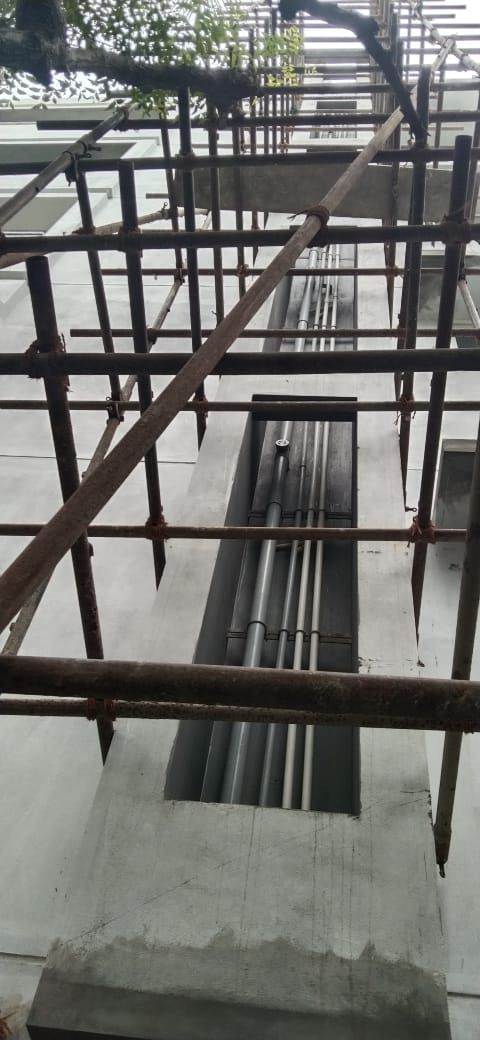

  • Lift wall cladding work is in progress. (50% completed)
  • 5th floor toilet wall tiles work is in progress. (upto 4th floor completed)
  • 5thfloor general flooring work is in progress. (upto4th floor completed)

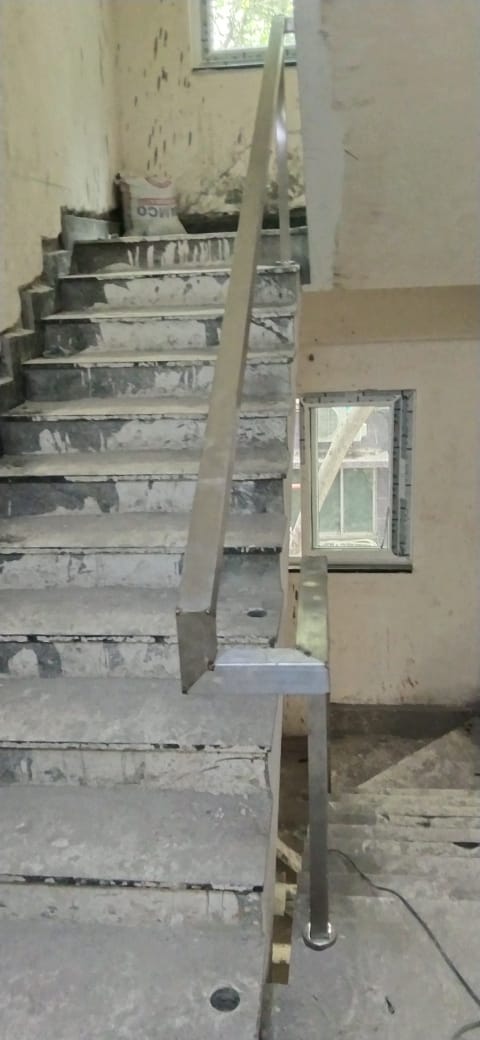

  • Staircase handrail work is in progress. (75% completed)

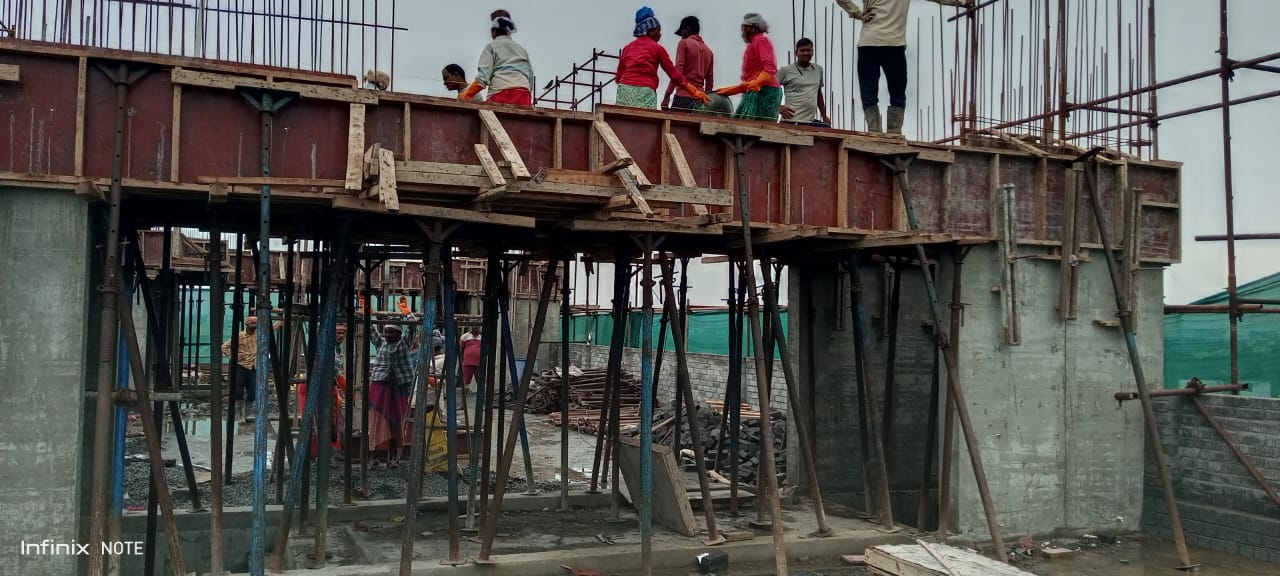

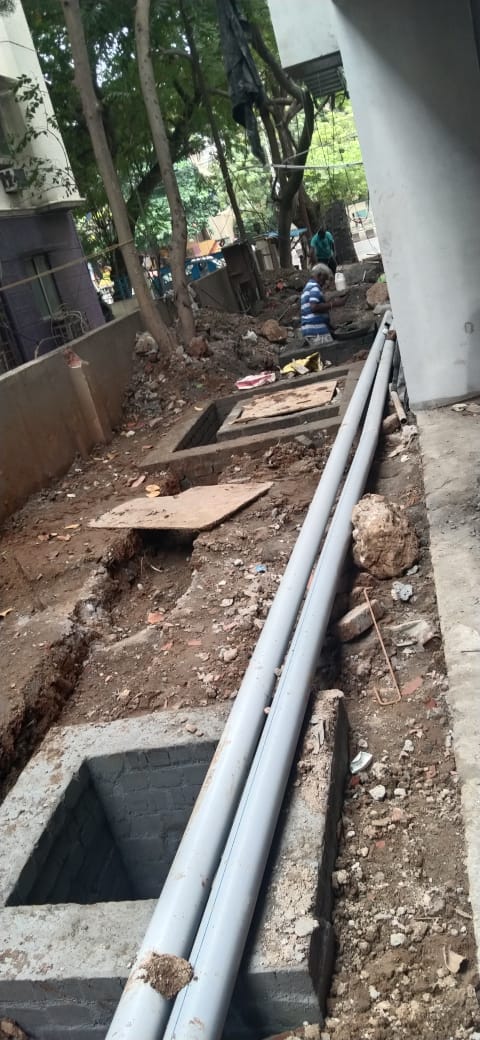

  • GSB set back filling work is in progress. (50% completed)

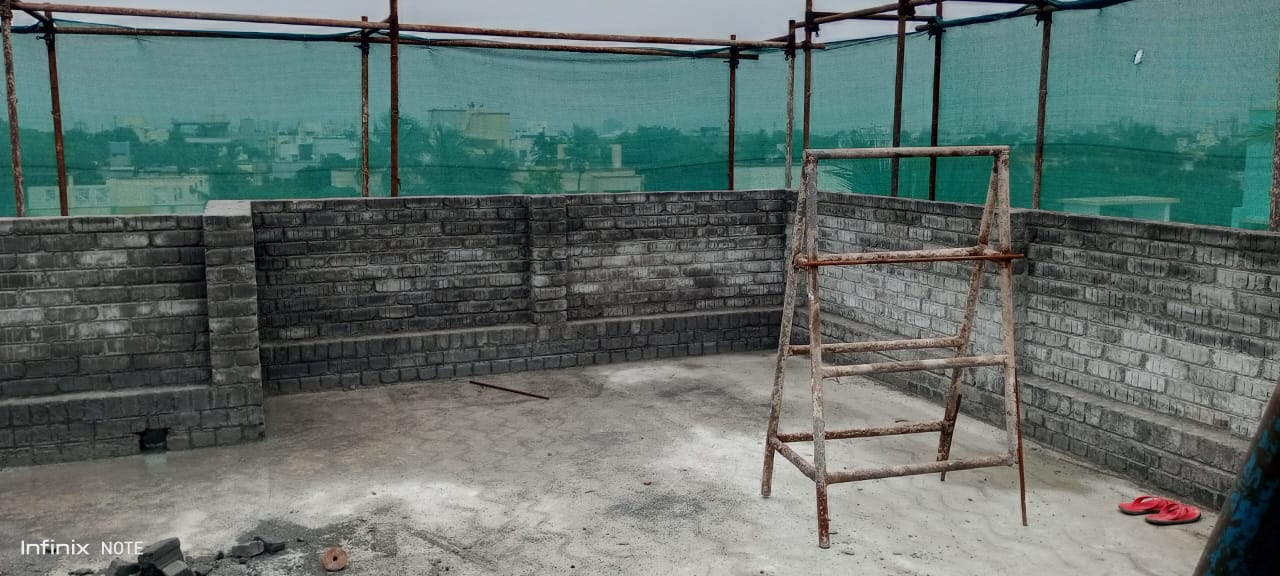

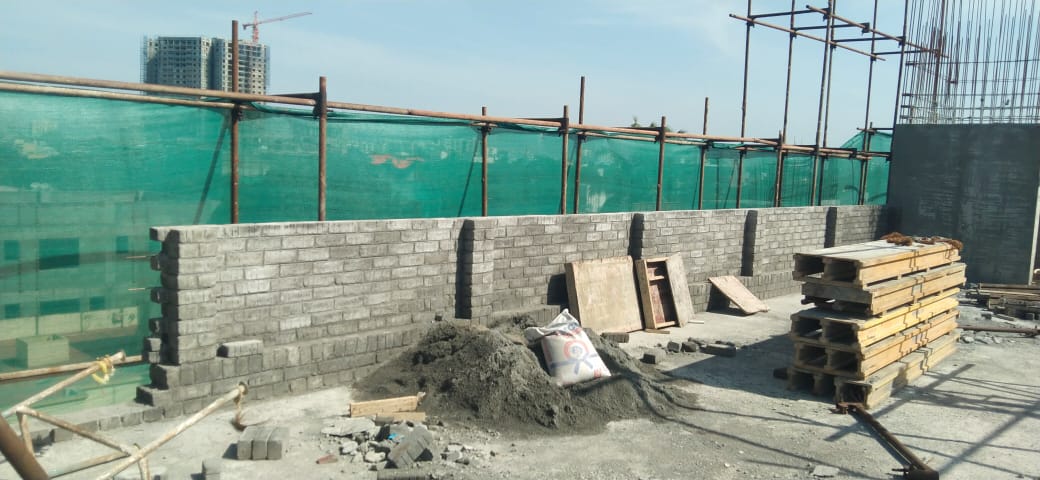

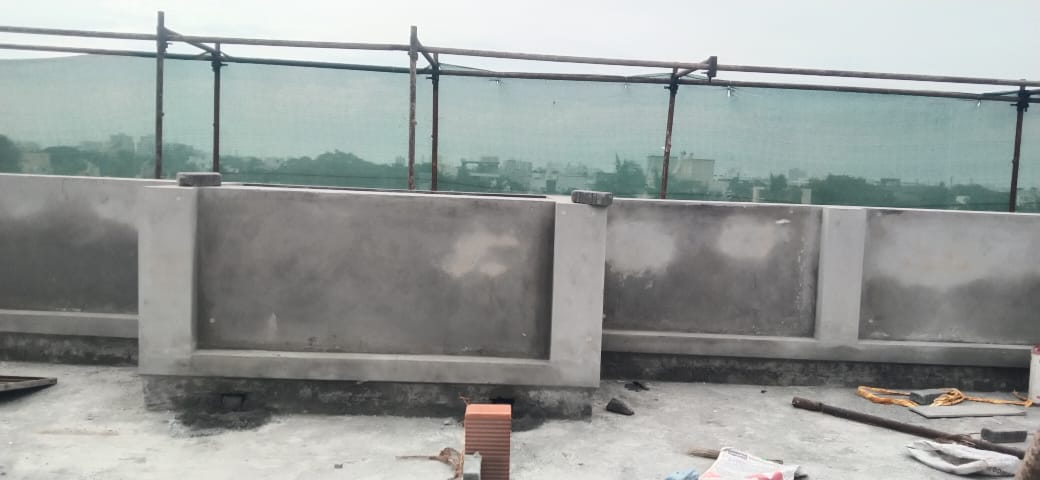

  • Compound wall work is completed.
  • Lift wall cladding work is in progress. (70% completed)

Property Location

Let your dreams be our

next Project!

Include your country code — all international formats are accepted (e.g. +91, +1, +44, +971).
