Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 sales@ramaniyam.com

Anugraha

Ashok Nagar

Download Brochure

Download file

Enquire Now

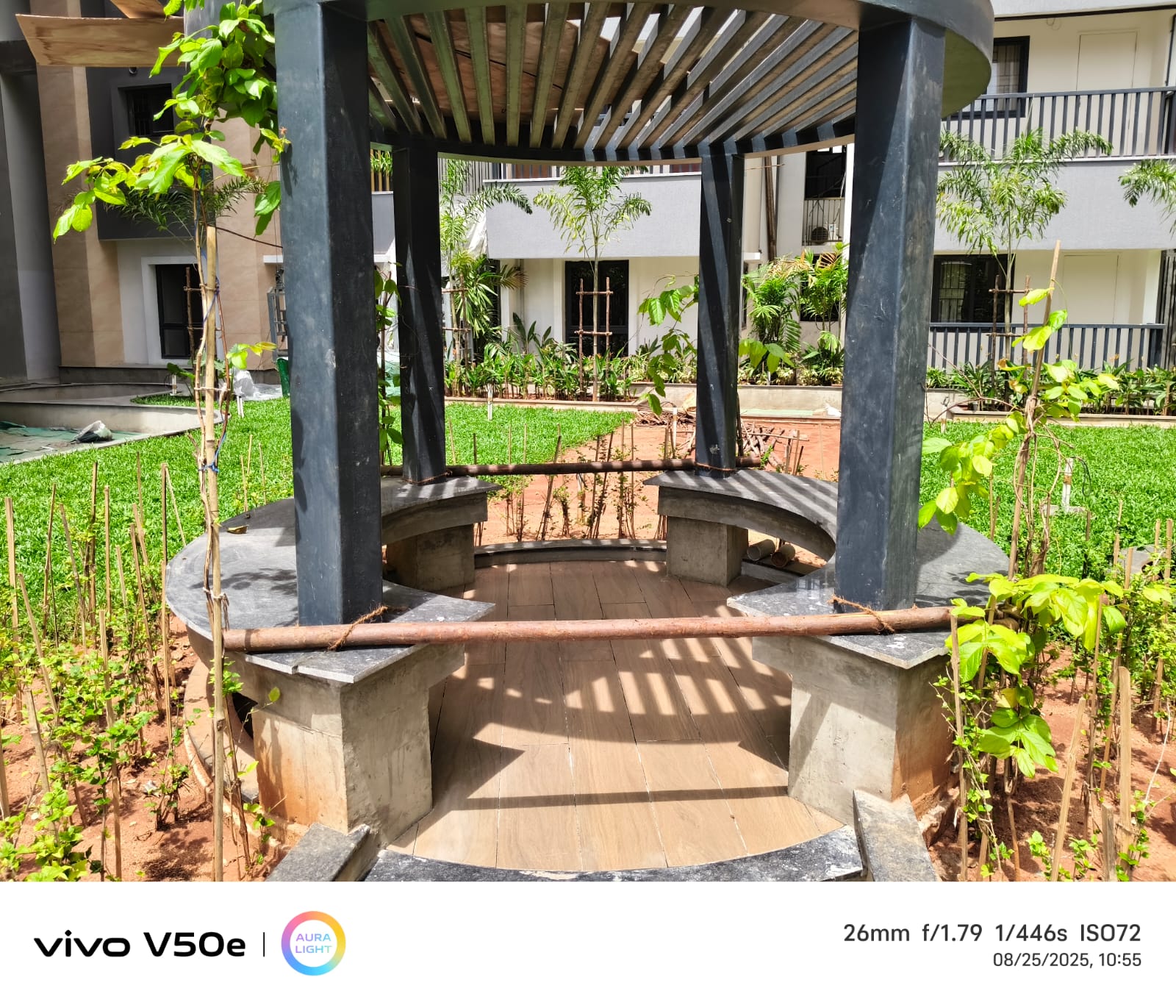

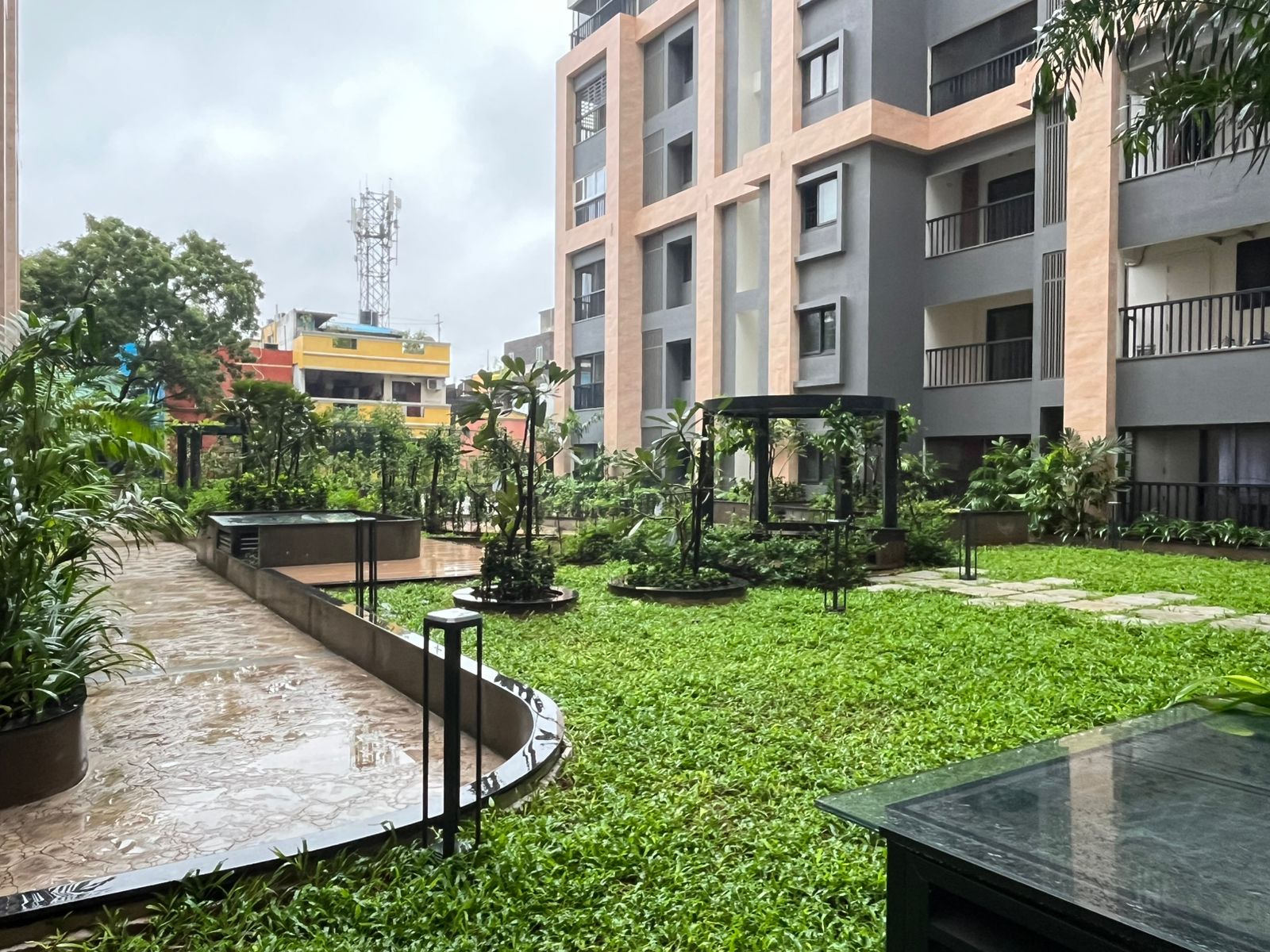

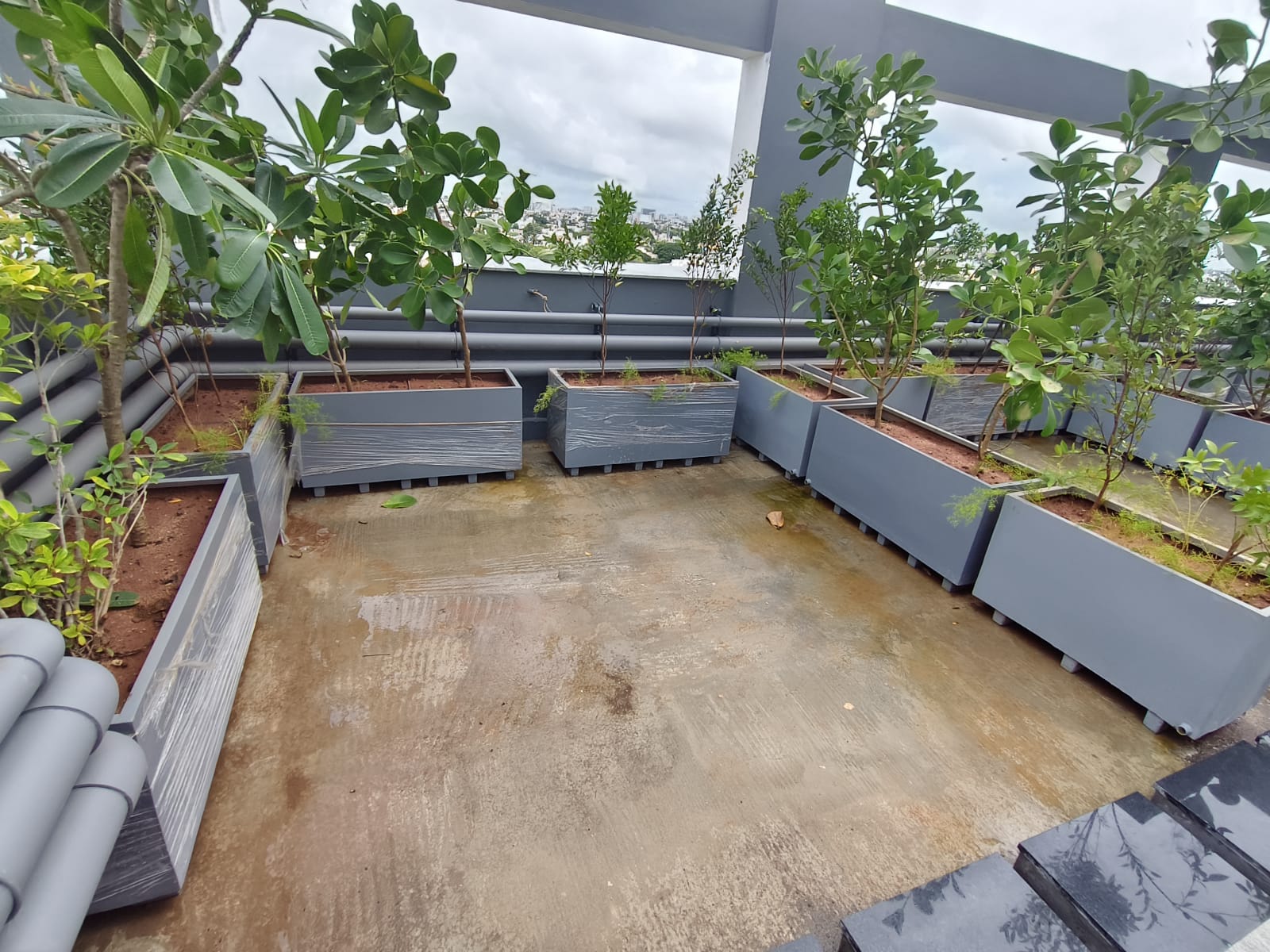

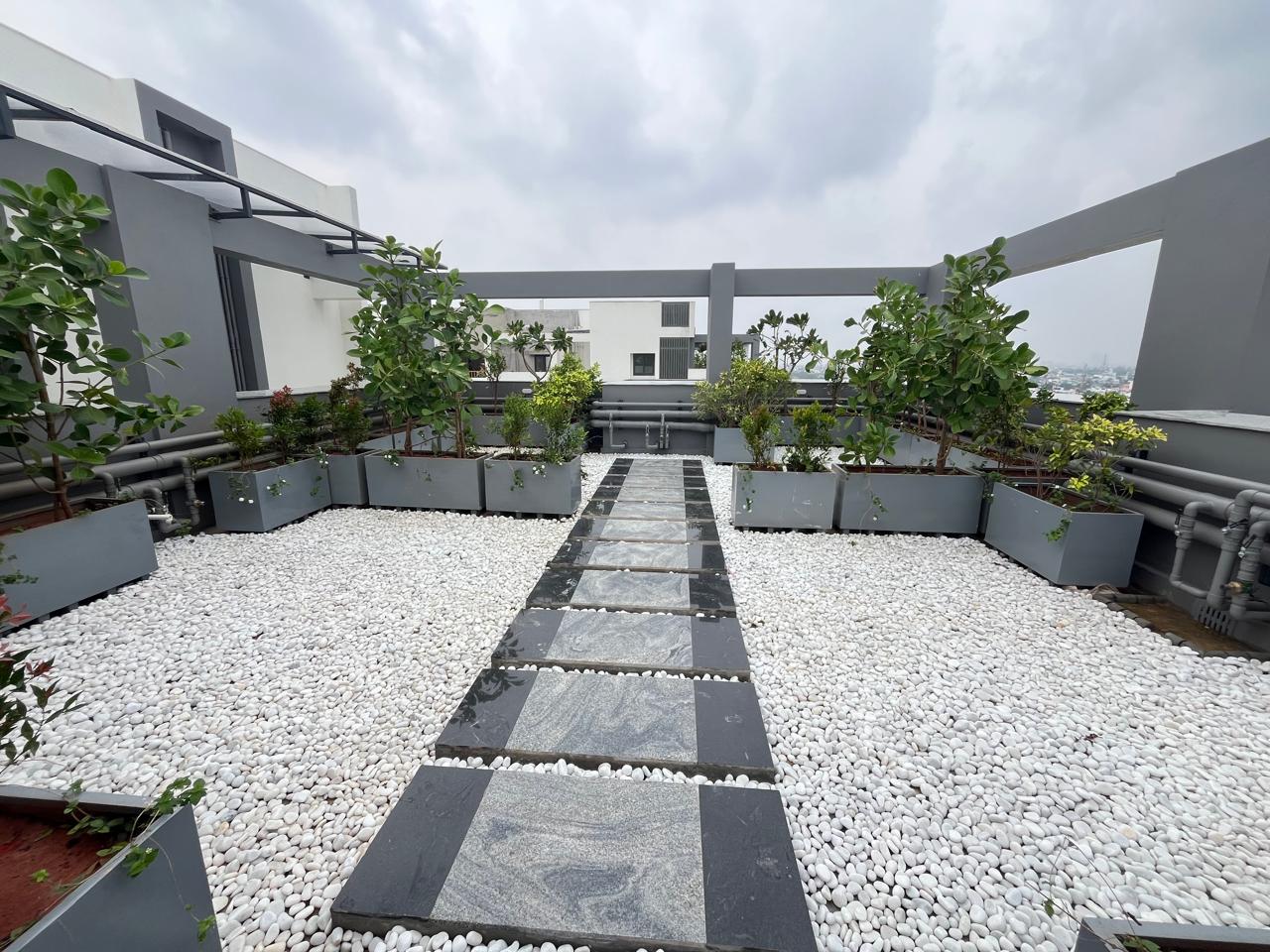

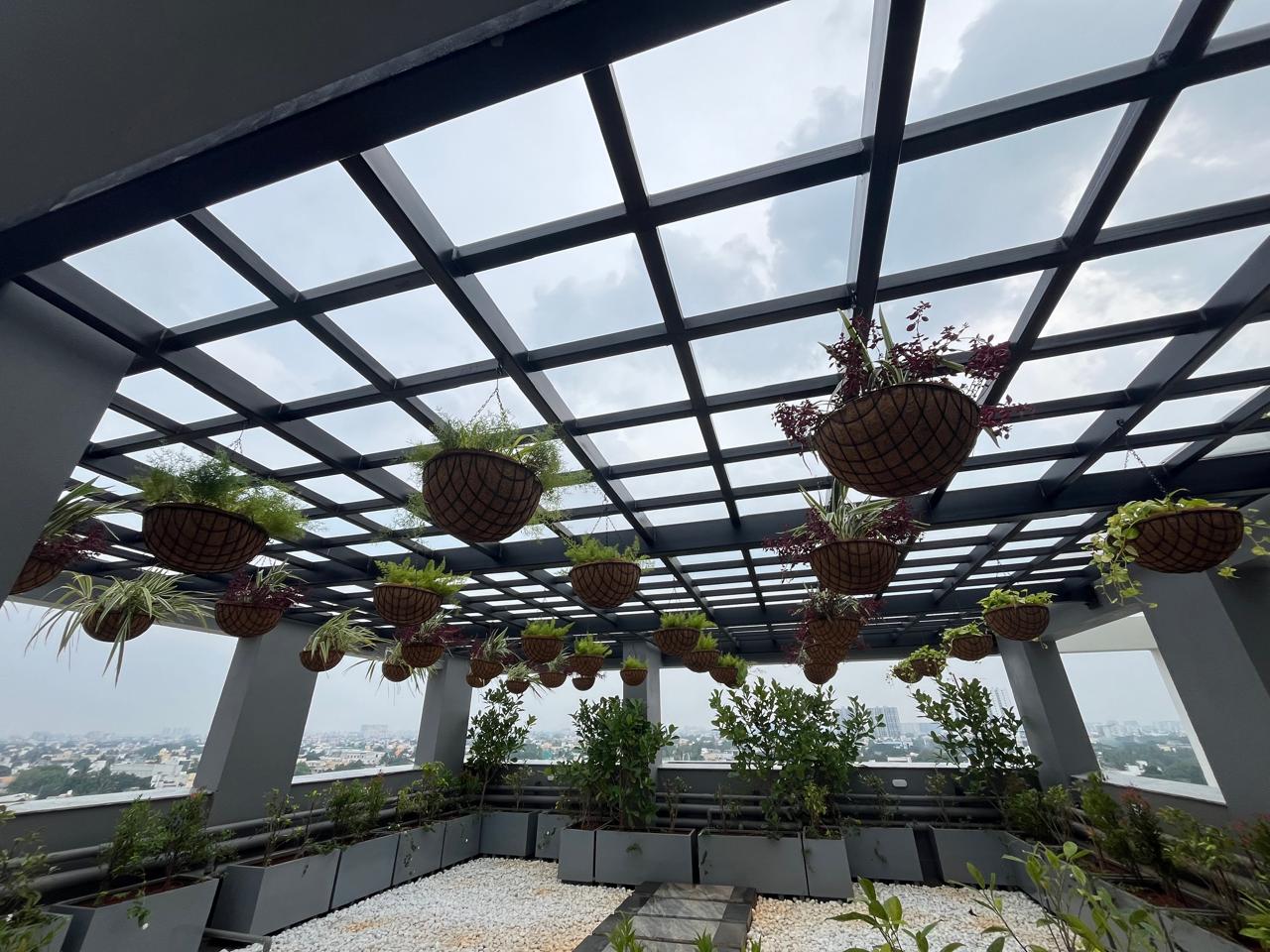

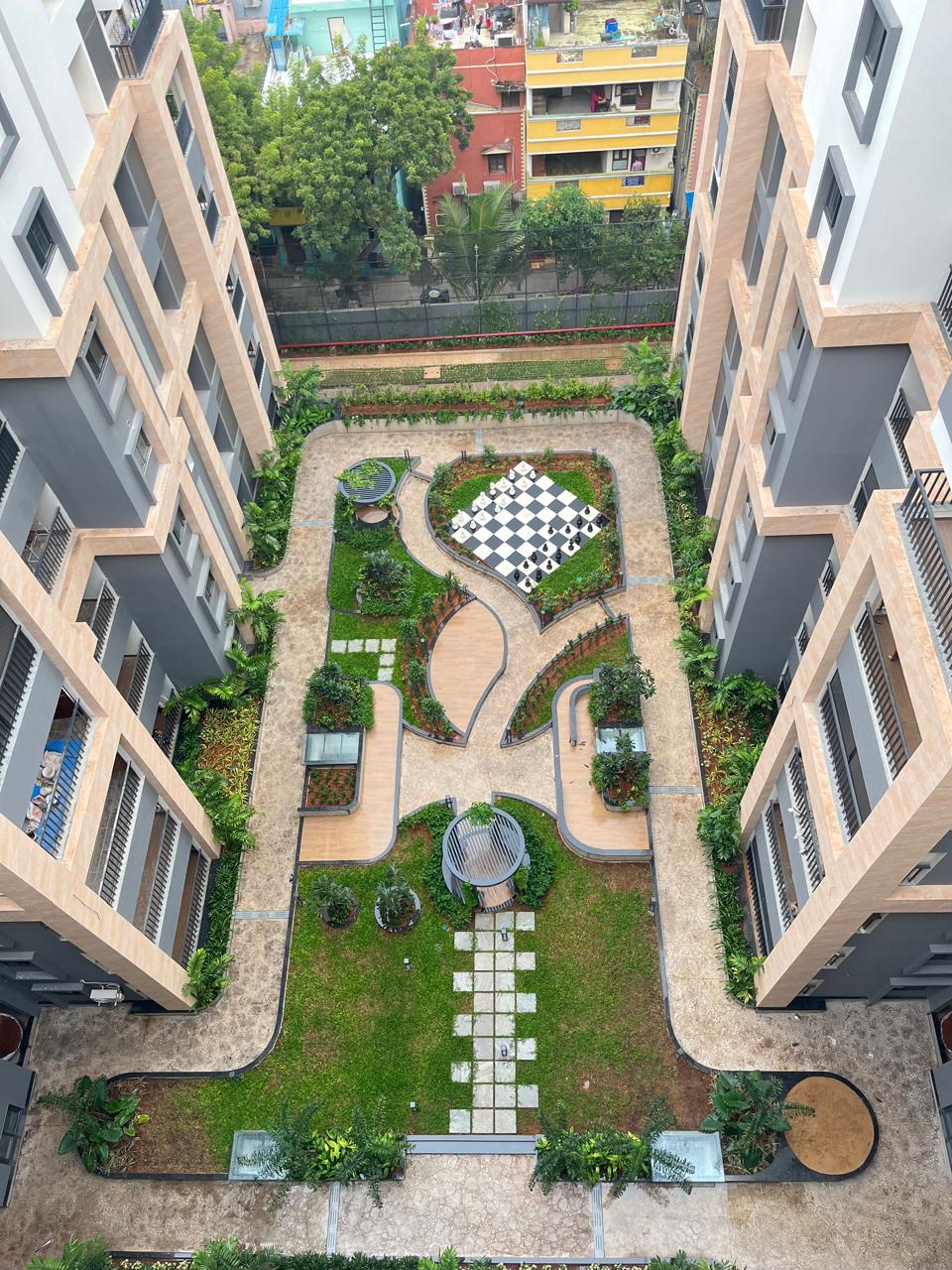

Amenities

Gymnasium
CCTV
24/7 Power Backup

Lobby

Multi Purpose Hall
Rain Water Harvesting

Walking Track

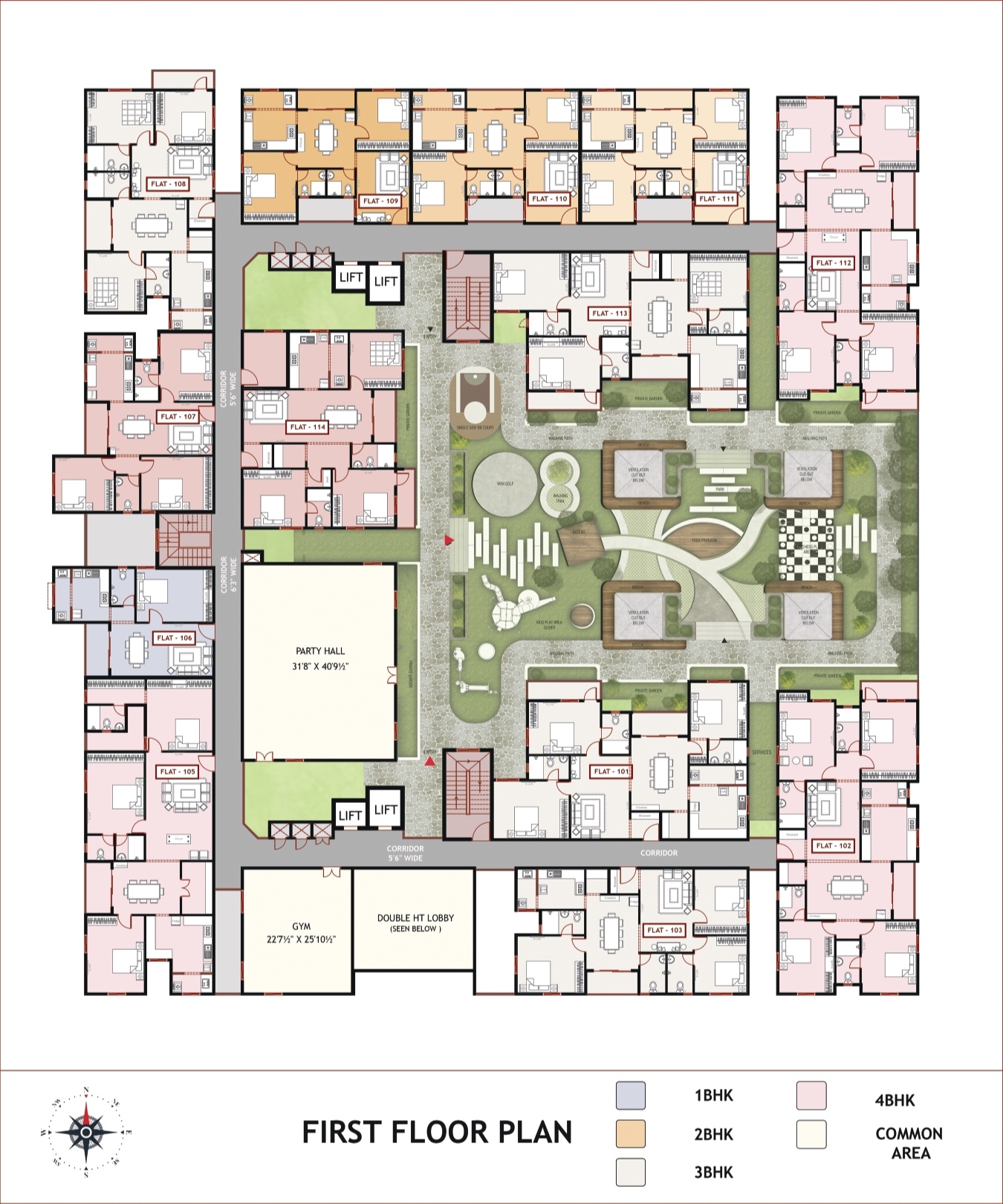

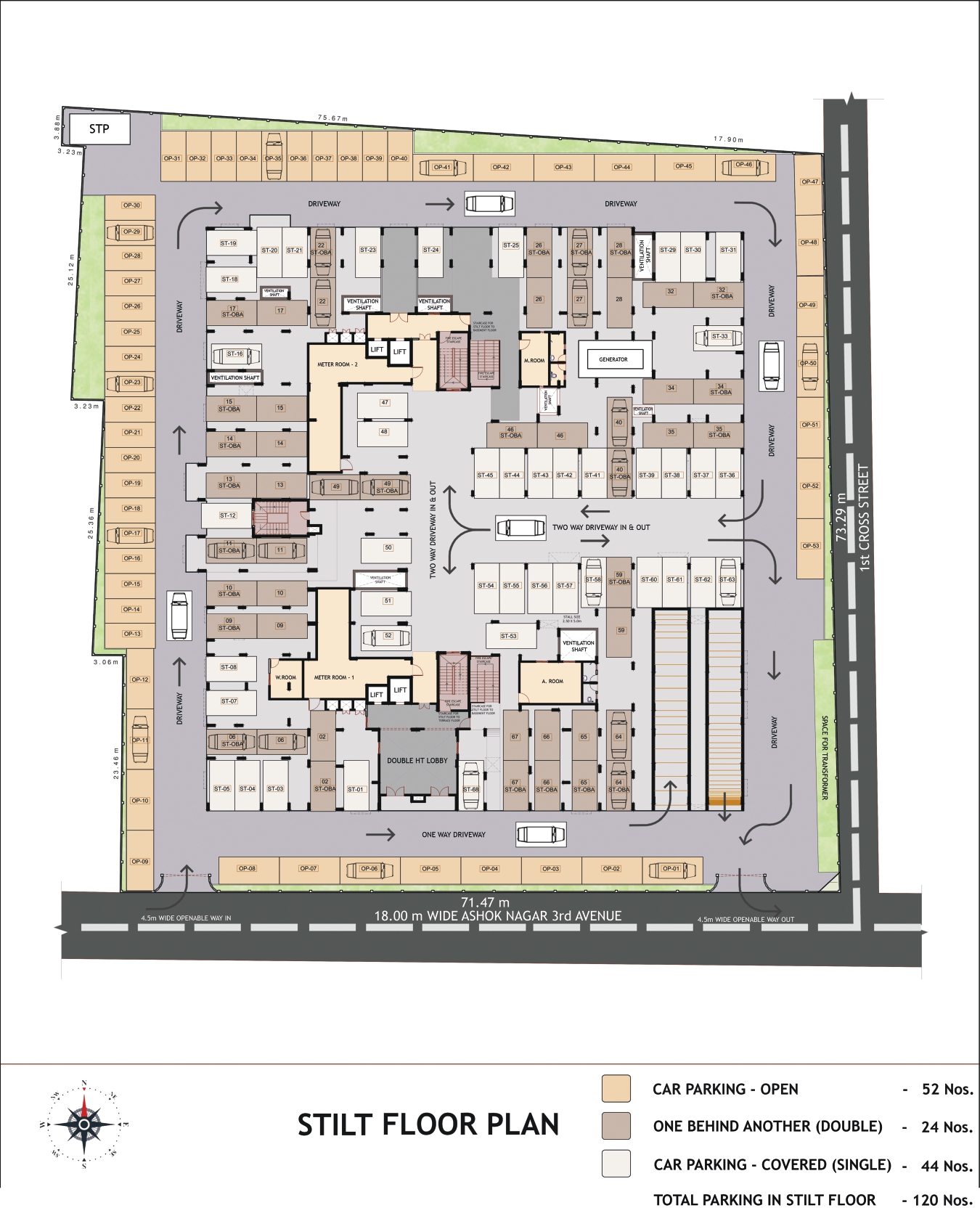

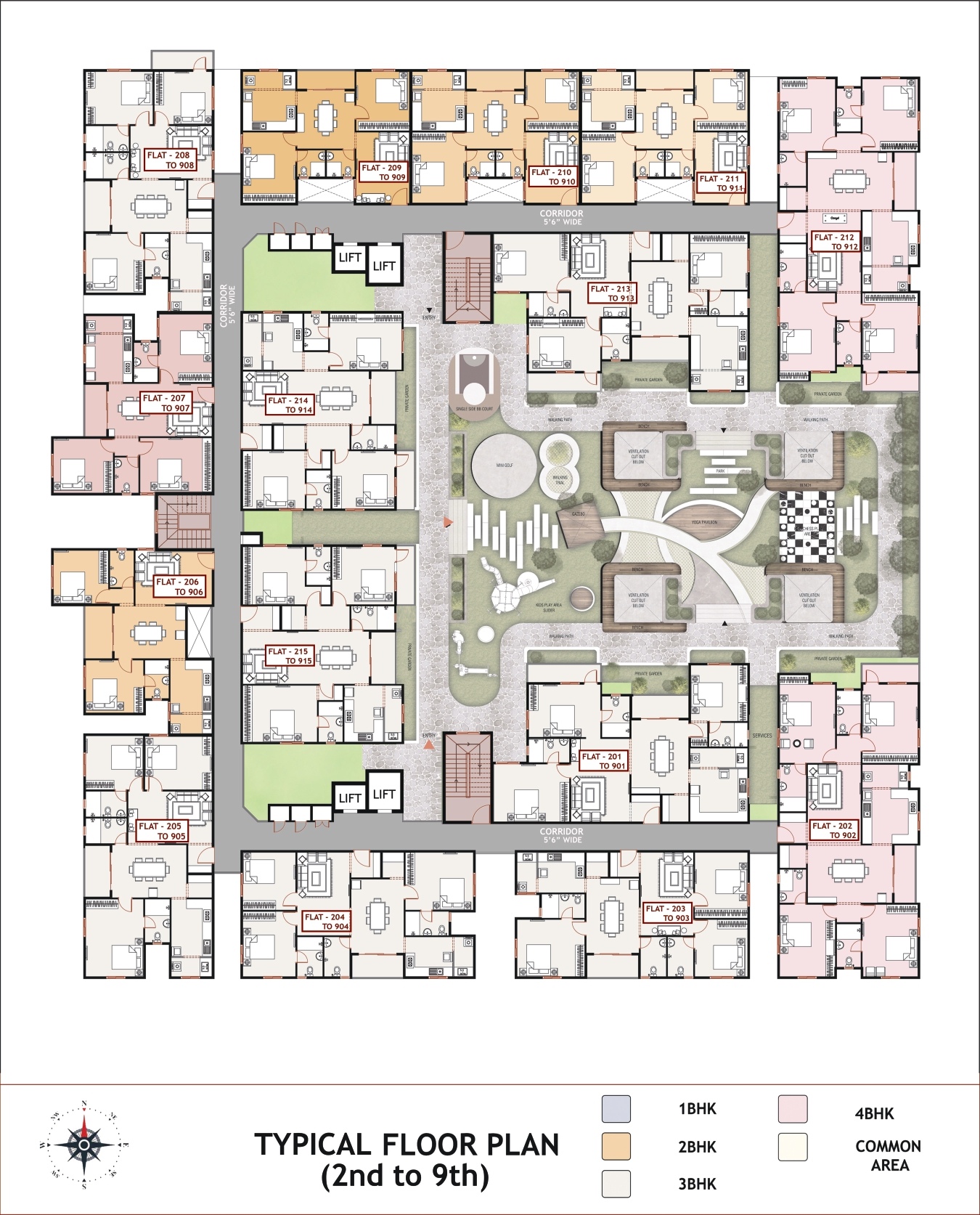

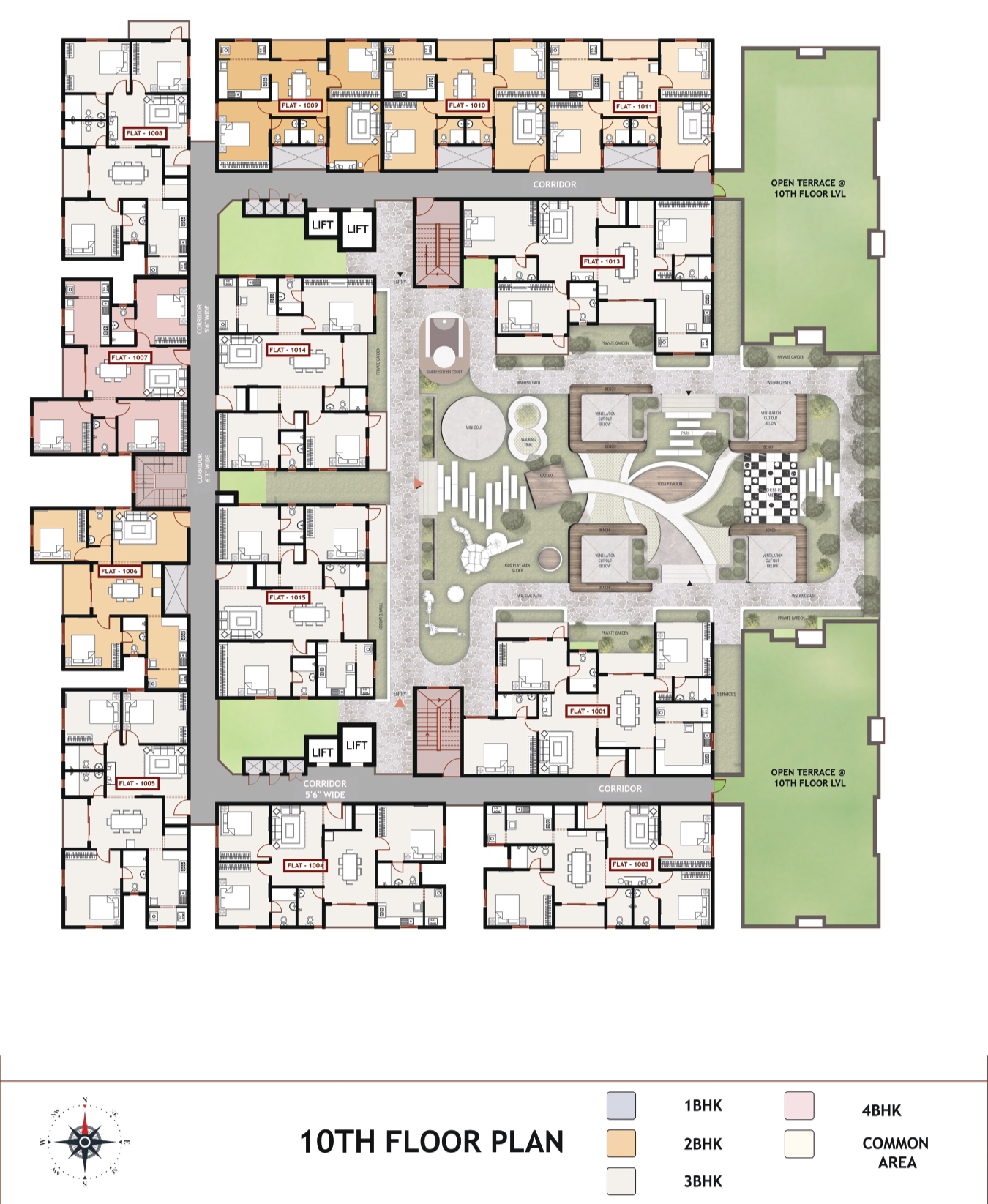

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
106 1 1BHK + 1T 863 East Available
112 1 4BHK + 4T 2277 West Available
710 7 2BHK + 2T 1137 South Available

Approvals

Planning Permit No:

PP/HRB/48/2022/ A to G

Date of Permit:

2022-11-15

Building Permission No:

CEBA/WDCN10/00360/2022

Date of Permit:

2022-11-23

TNRERA:

TN/29/Building/0495/2022

Dated:

2022-12-05

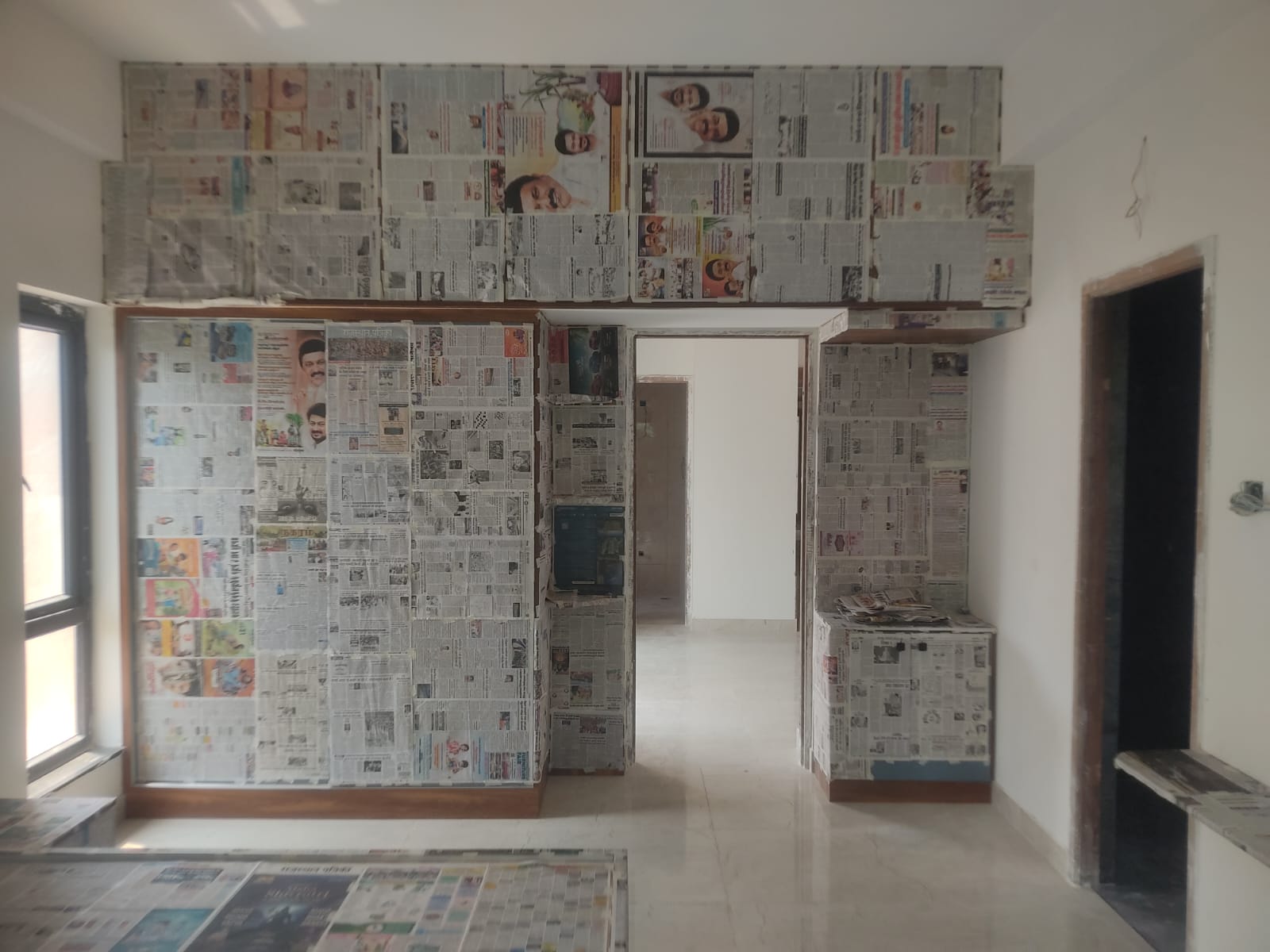

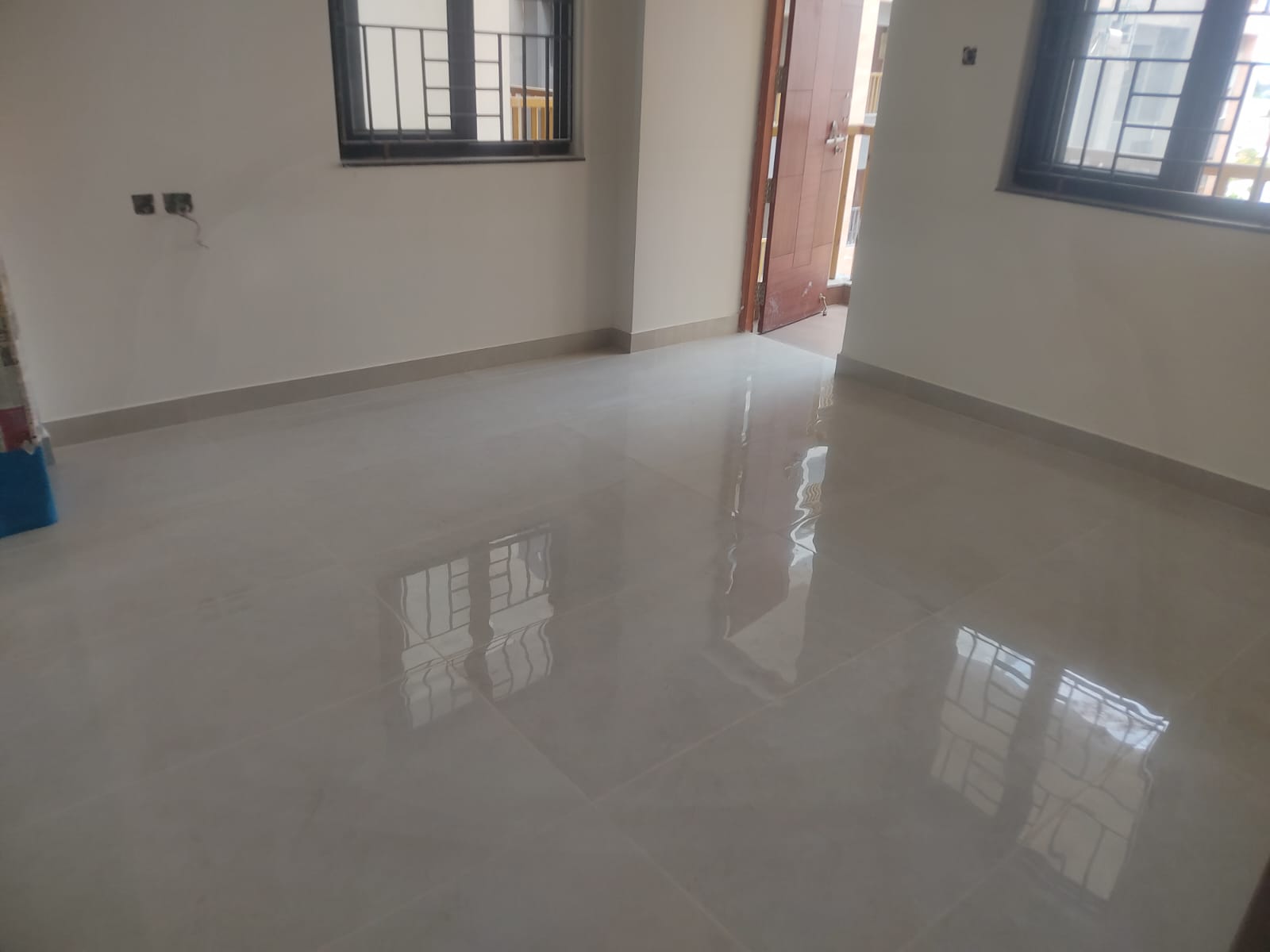

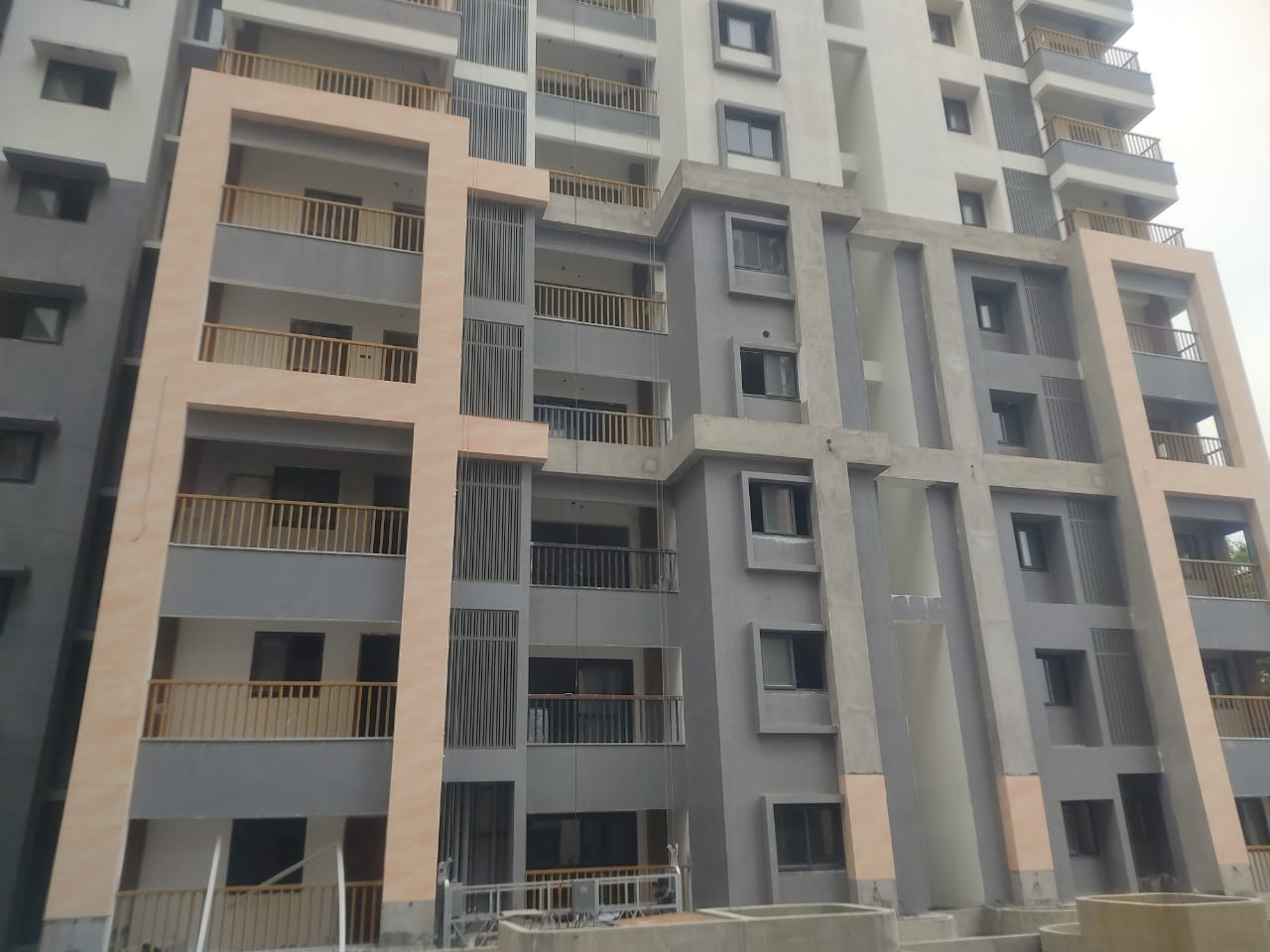

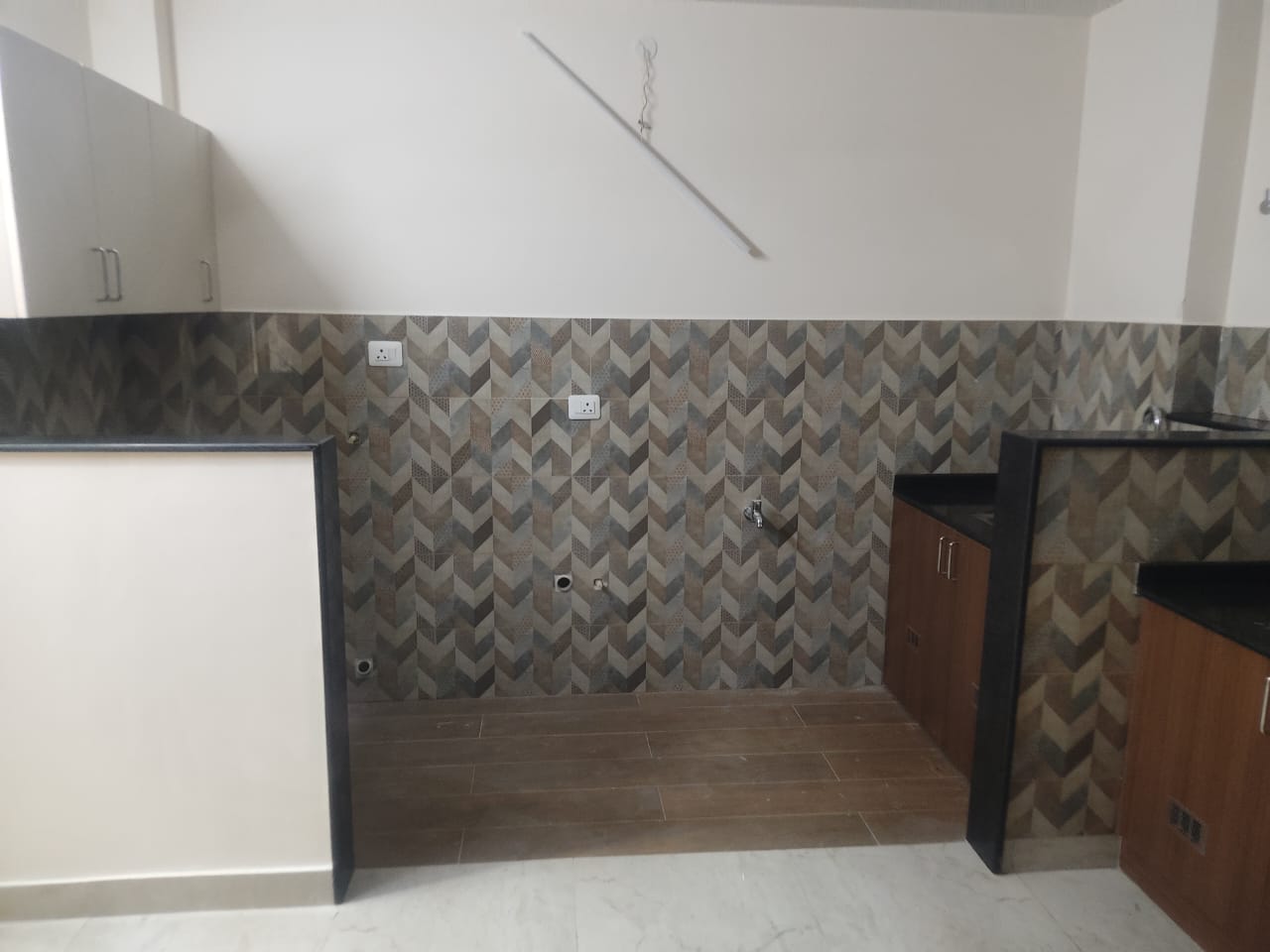

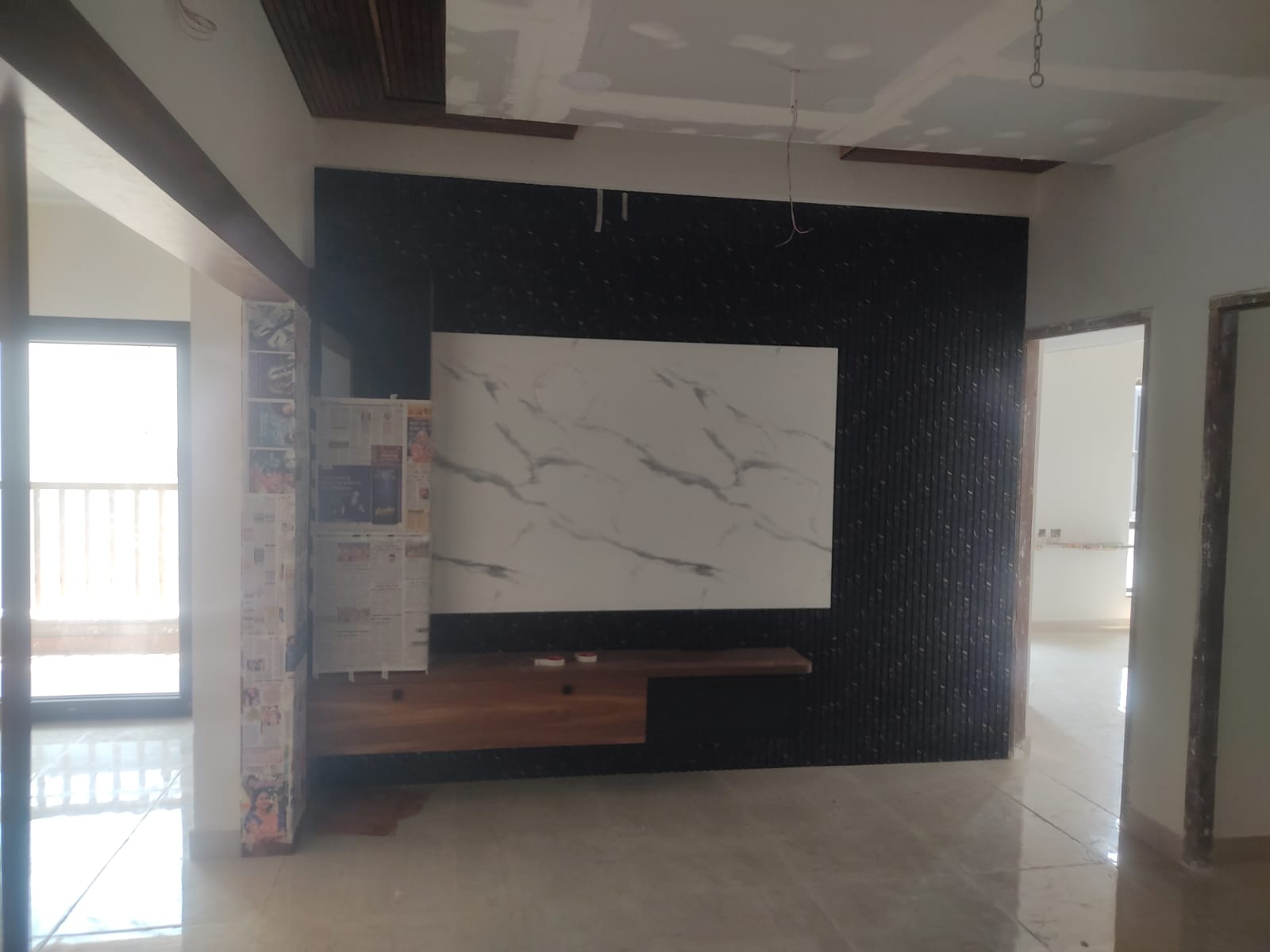

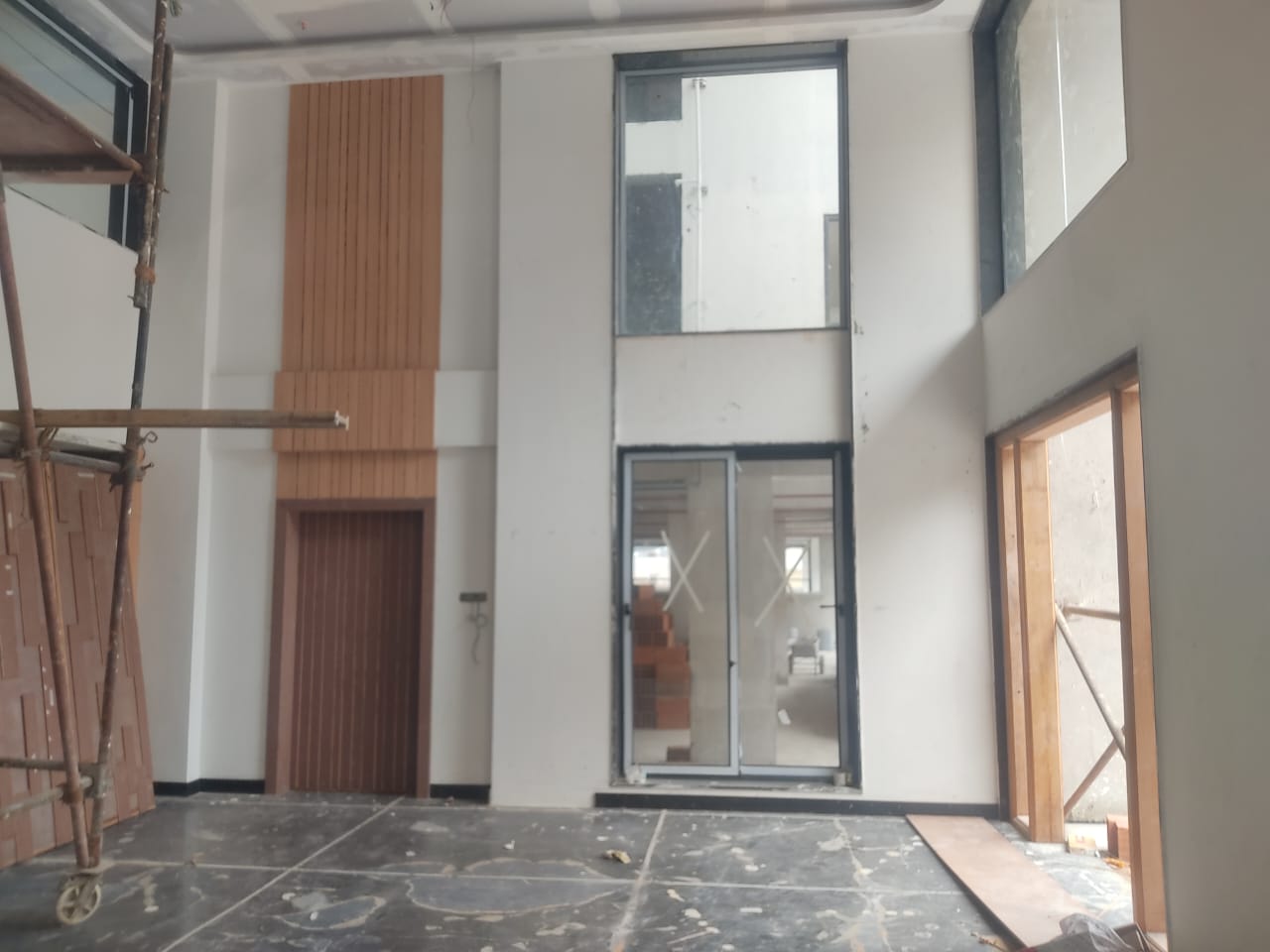

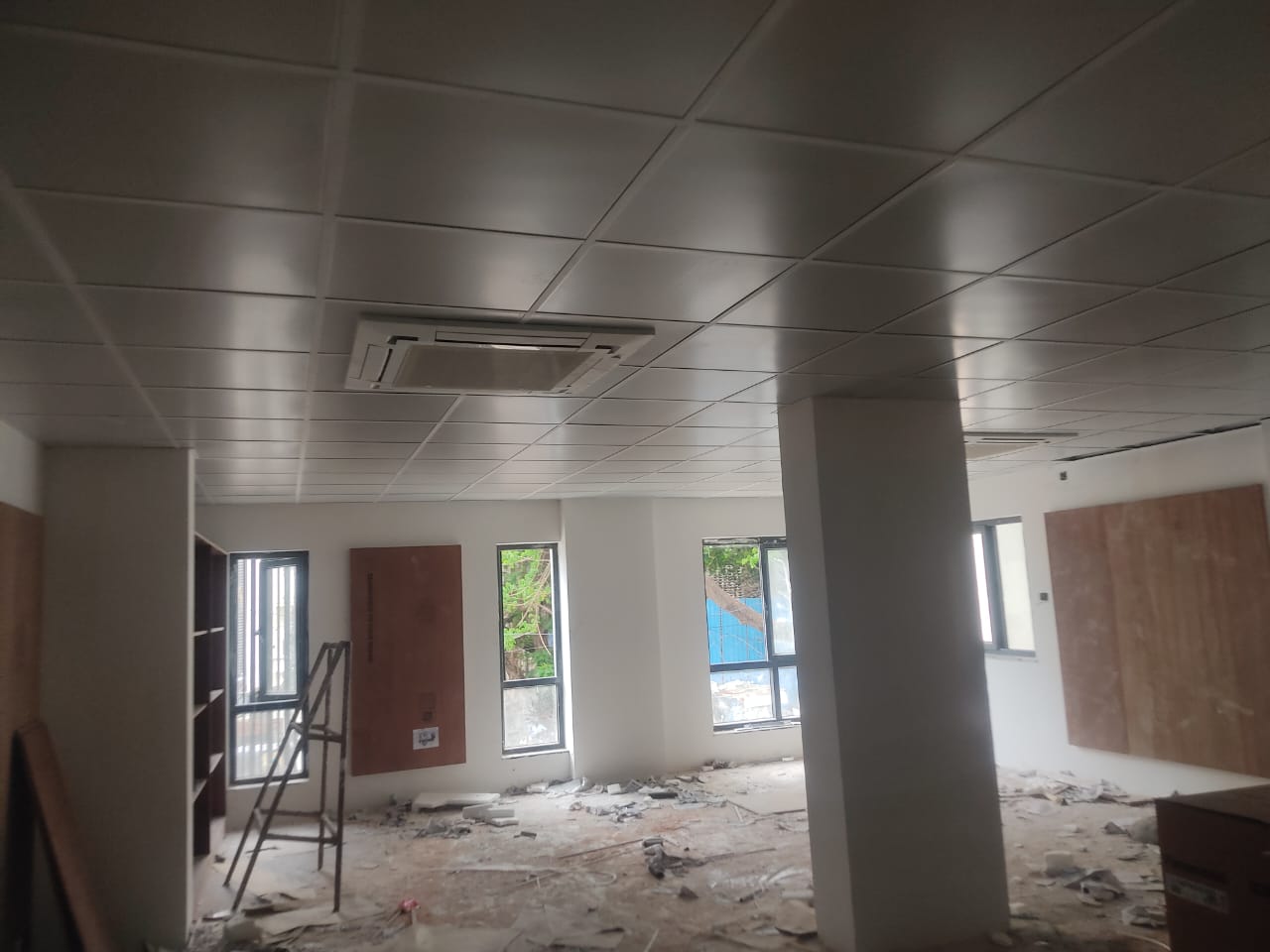

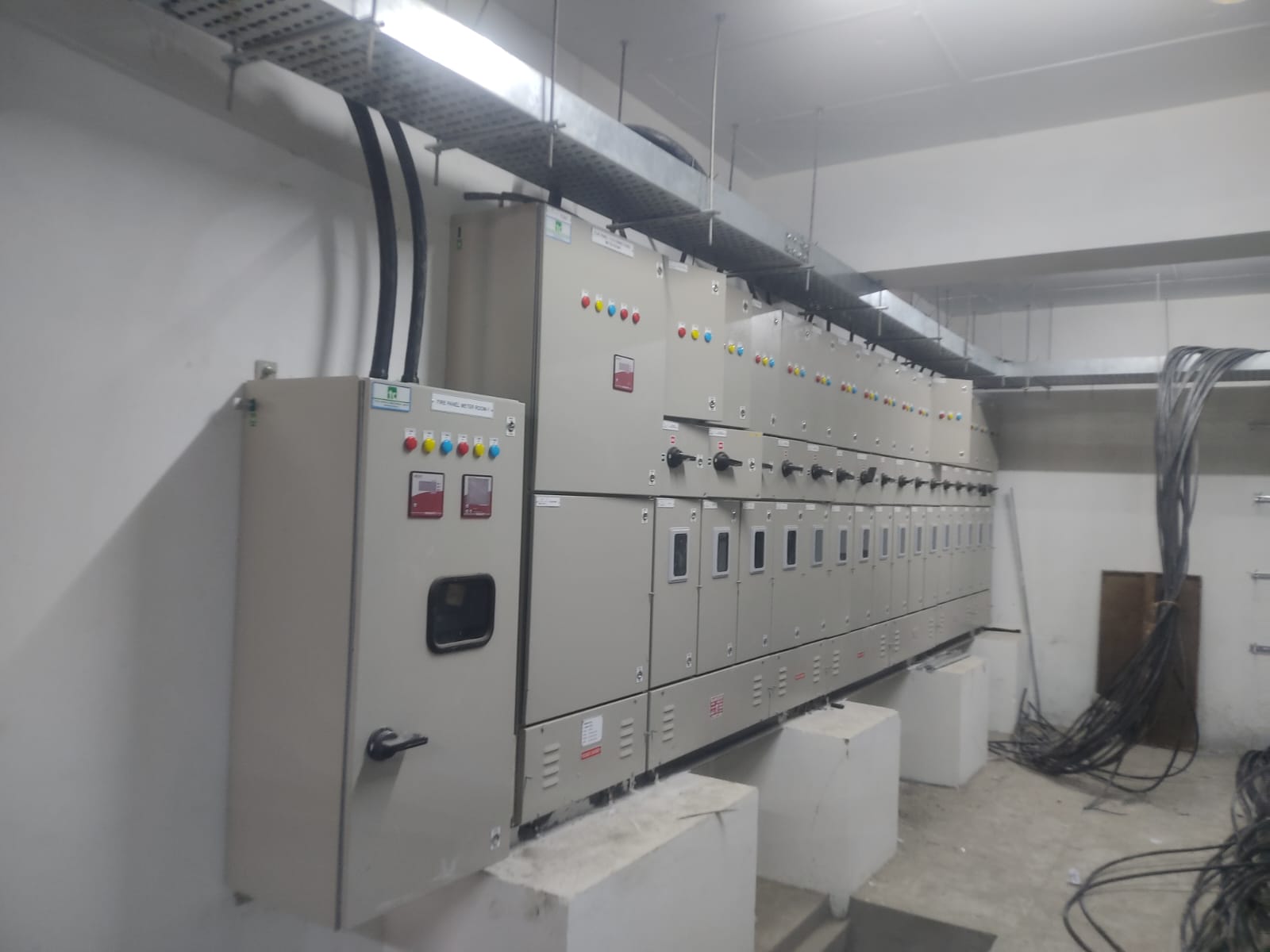

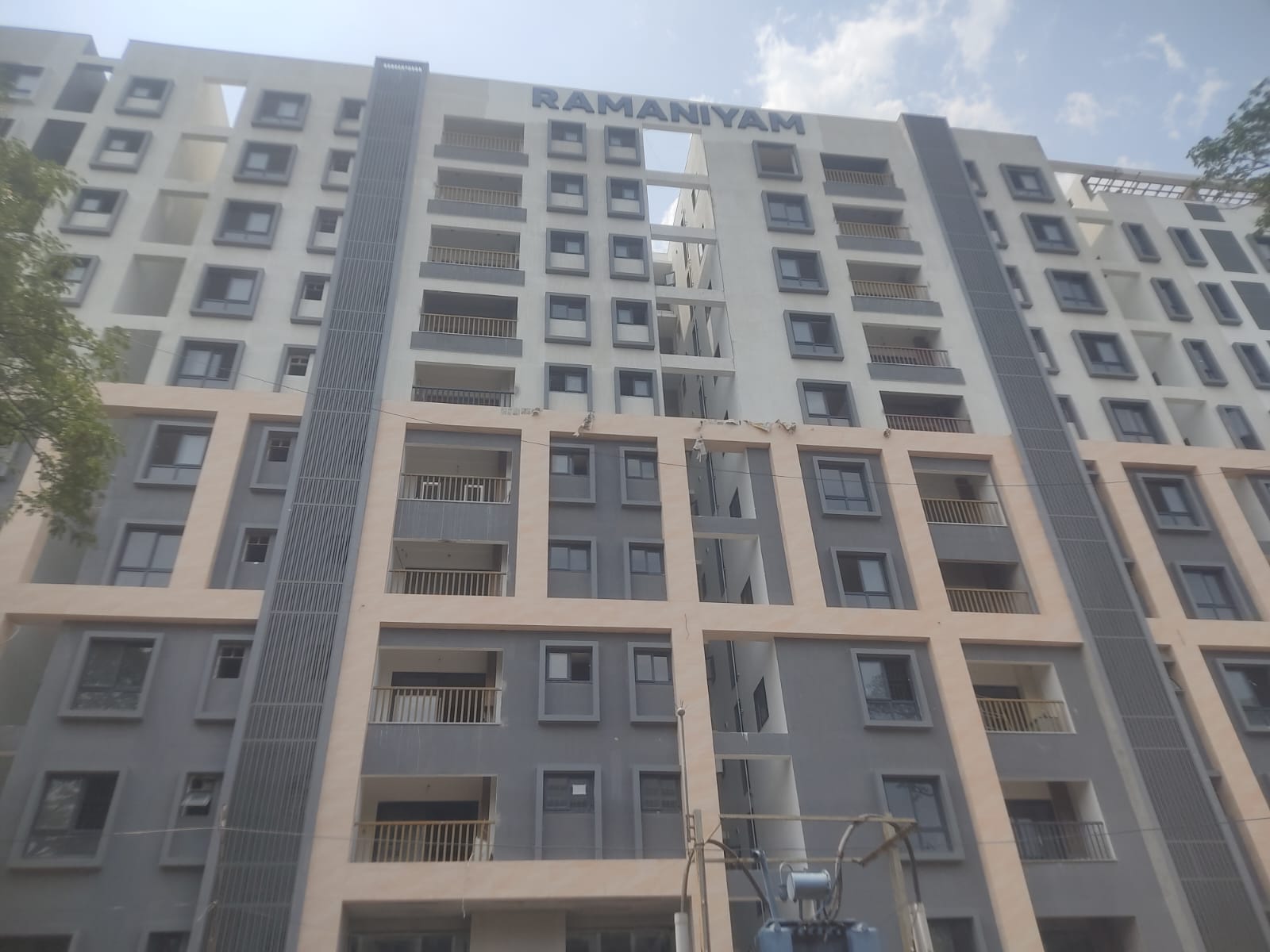

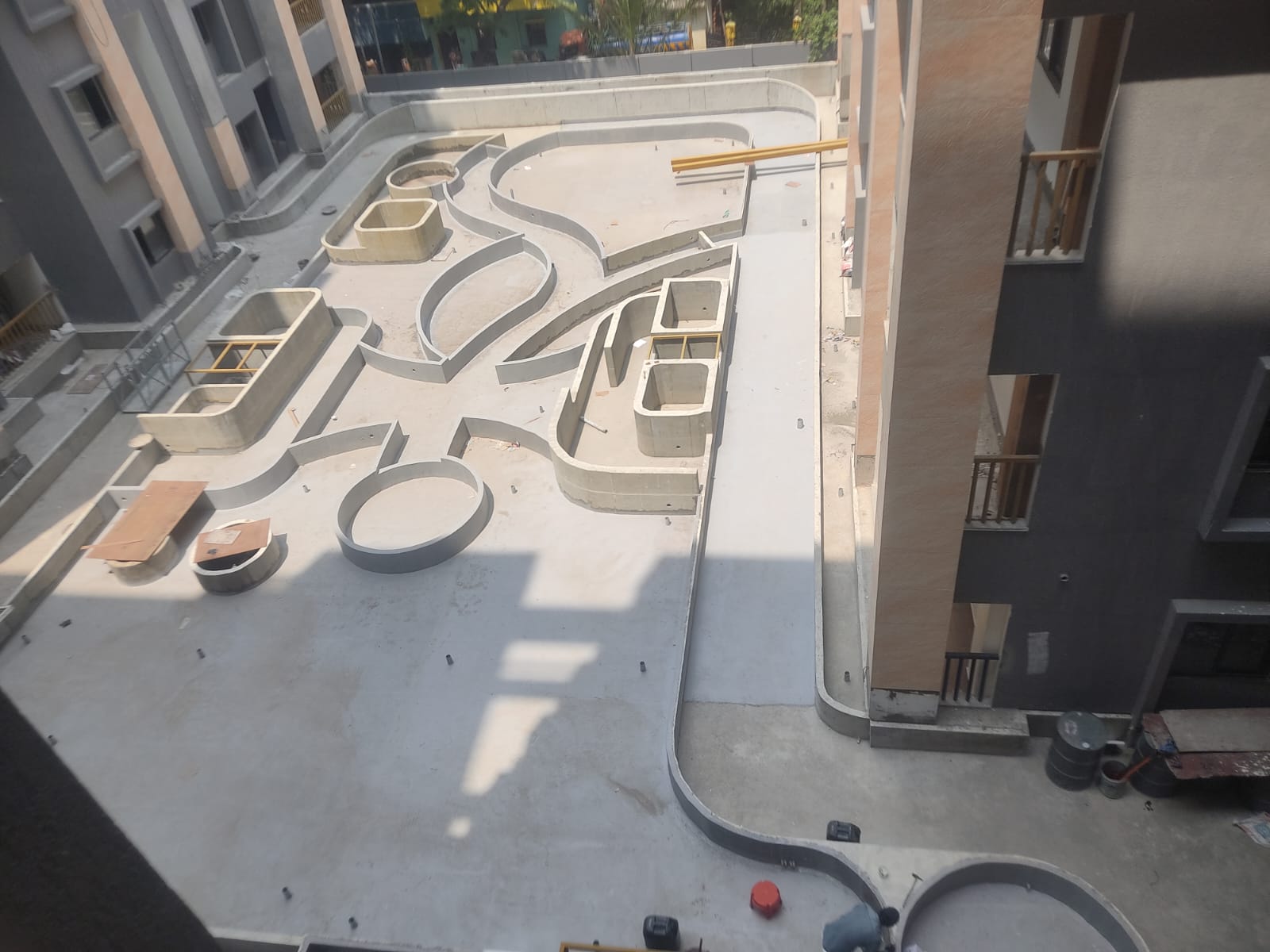

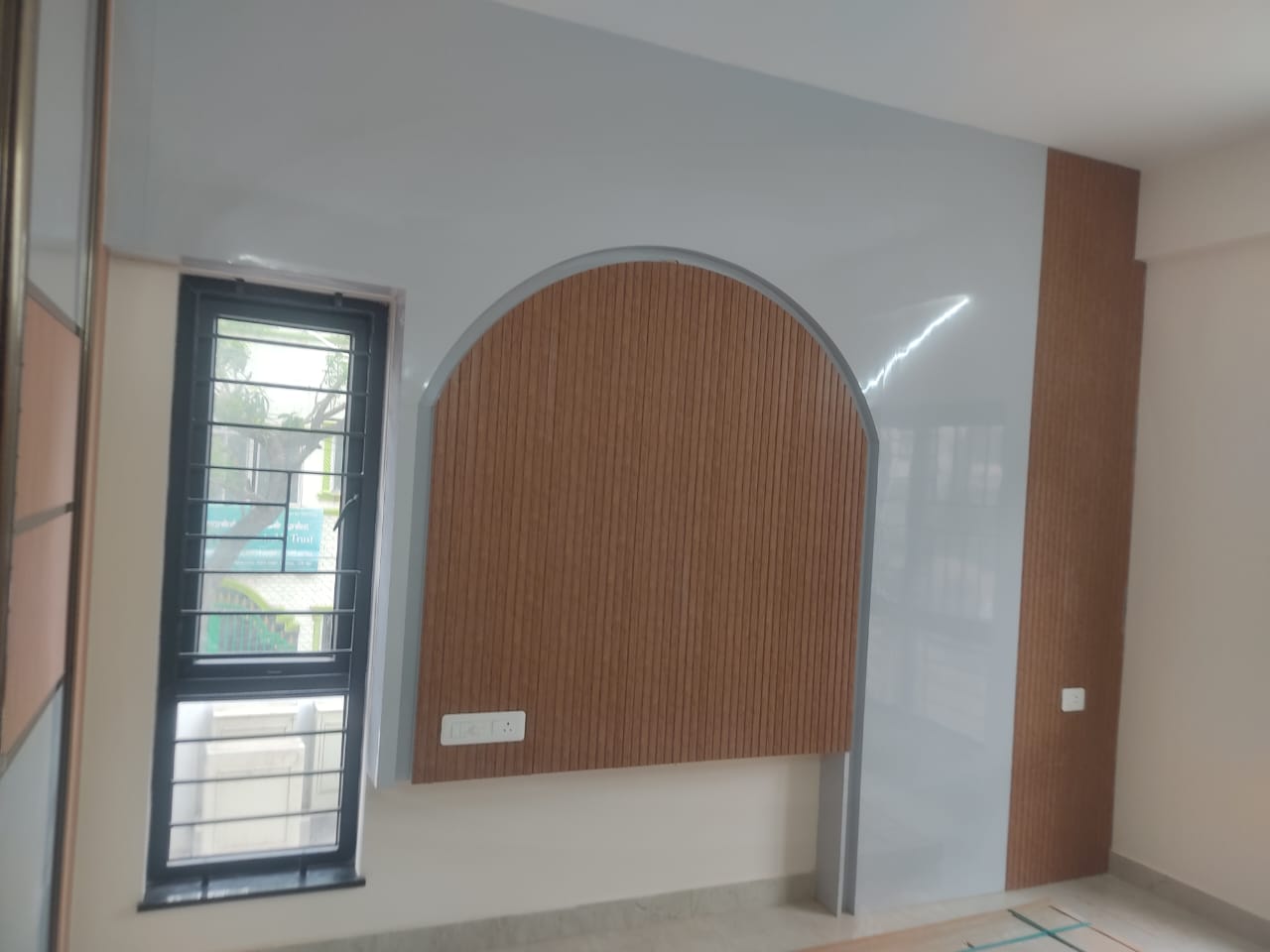

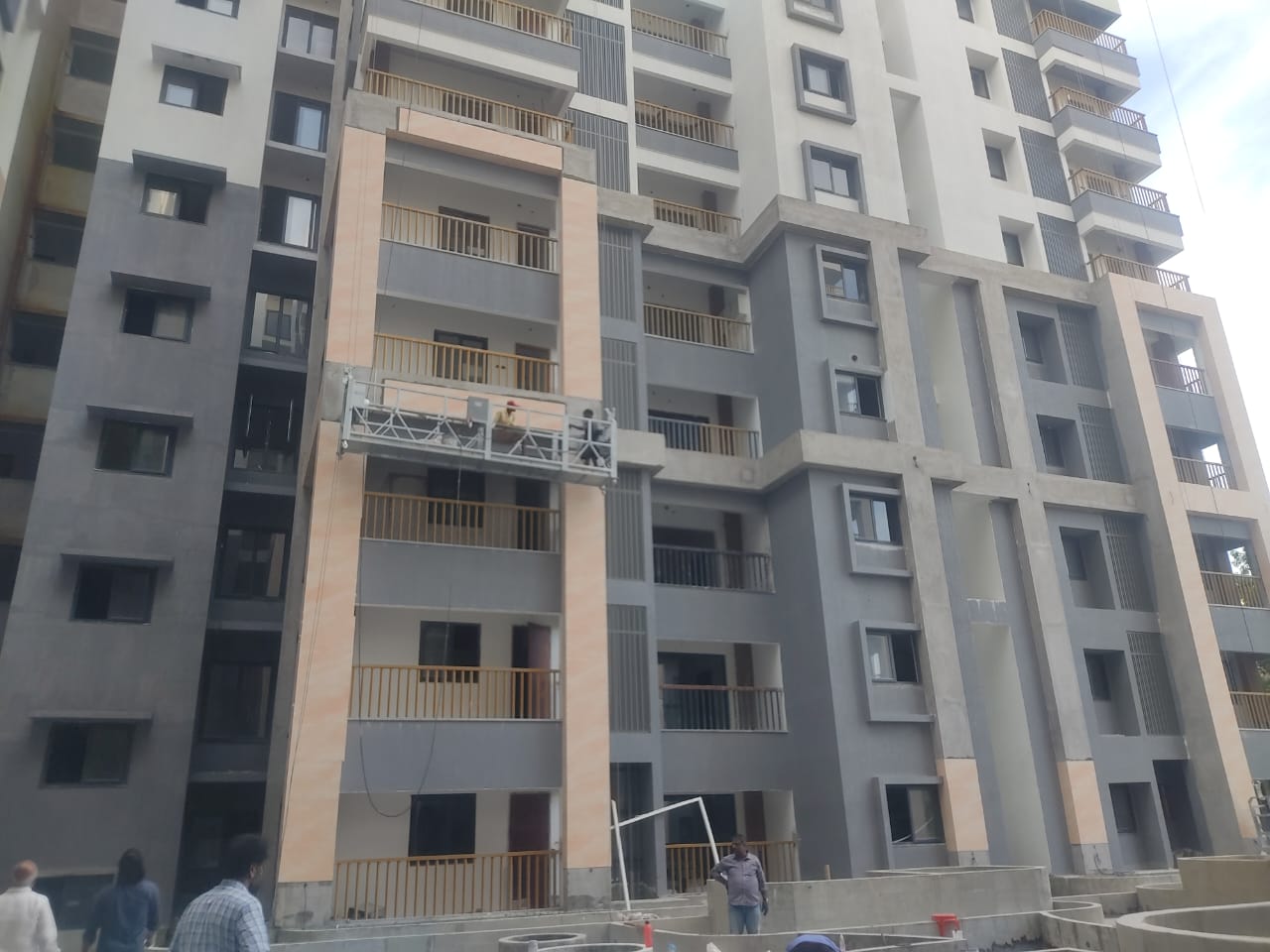

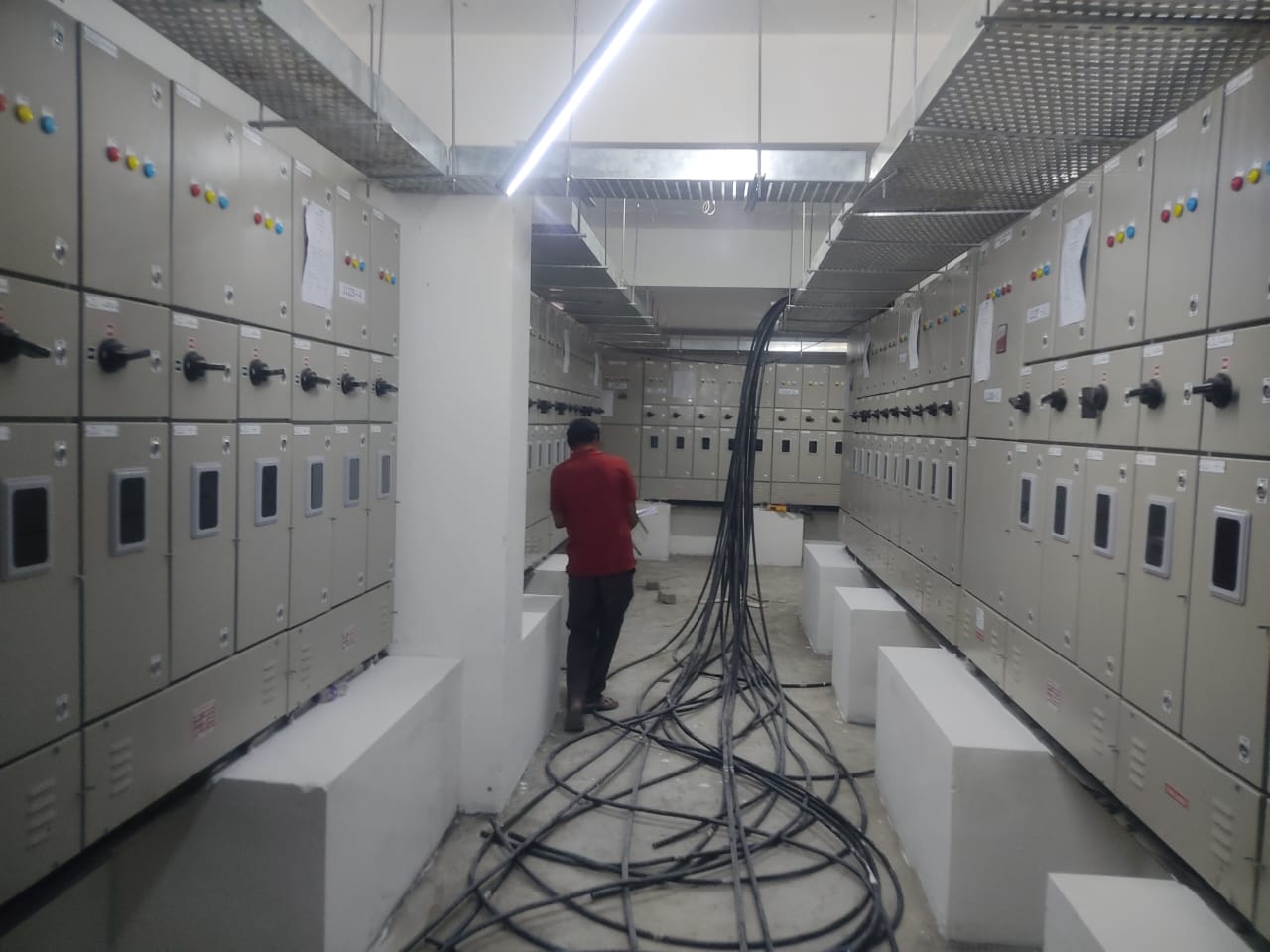

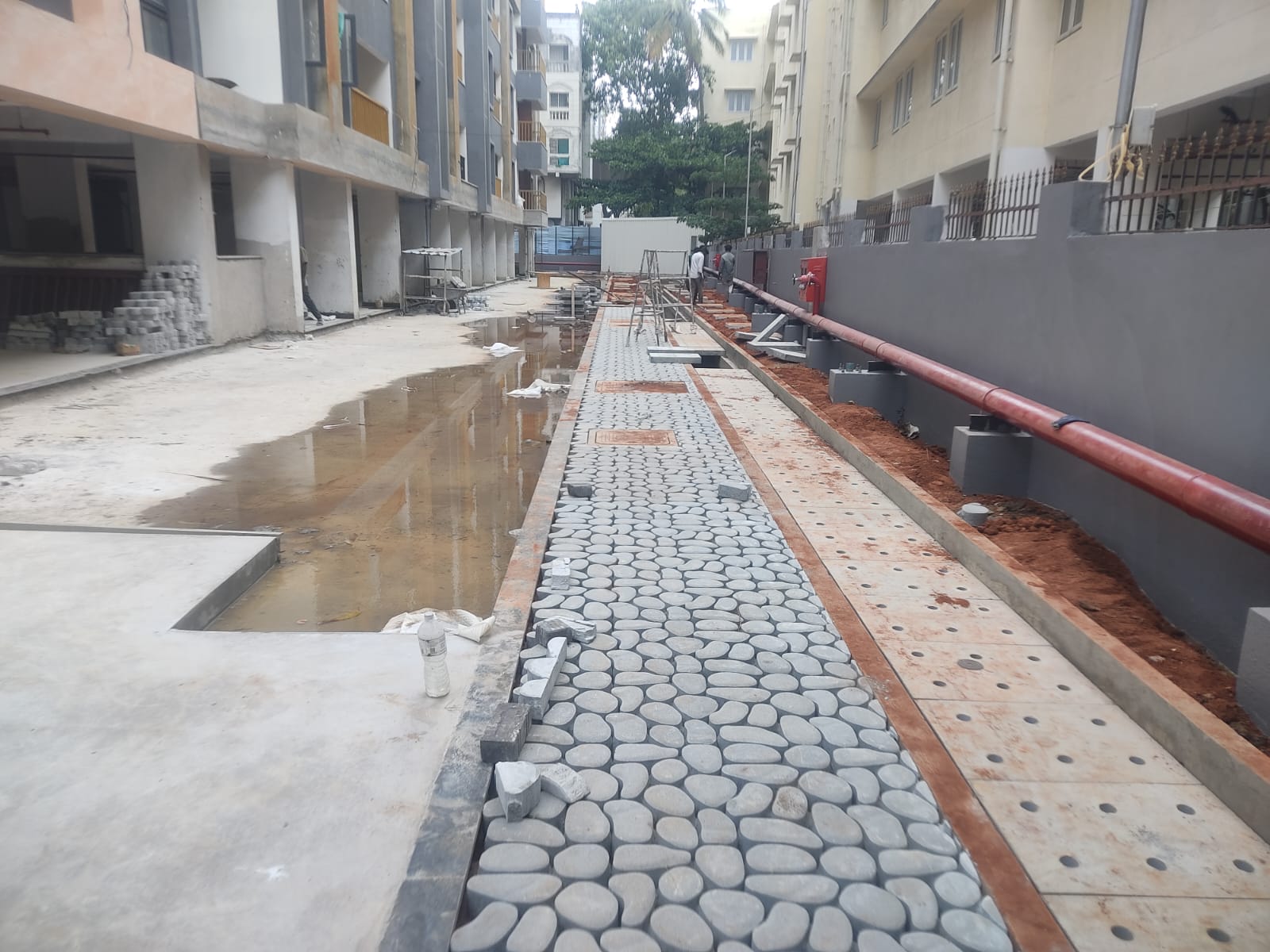

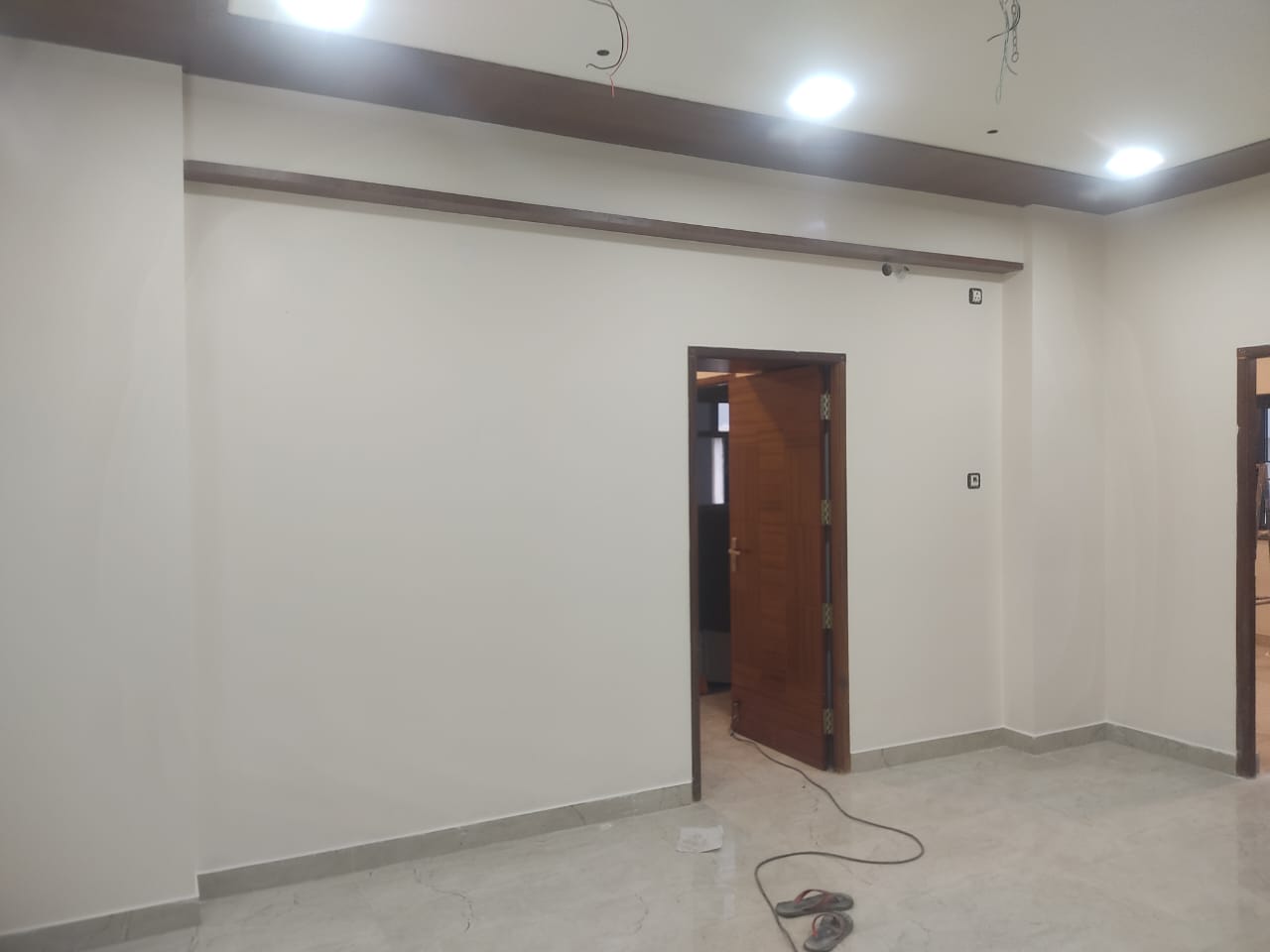

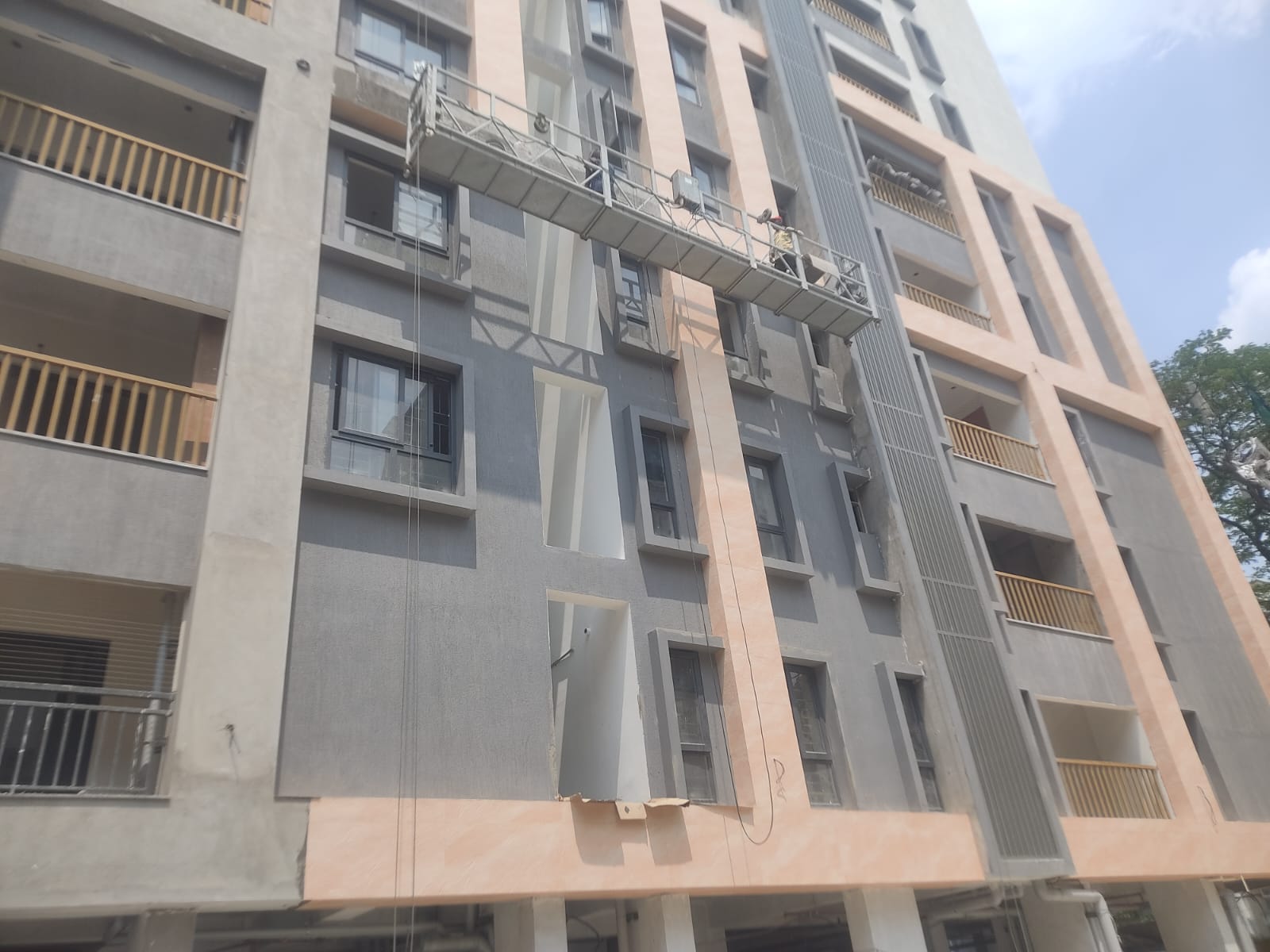

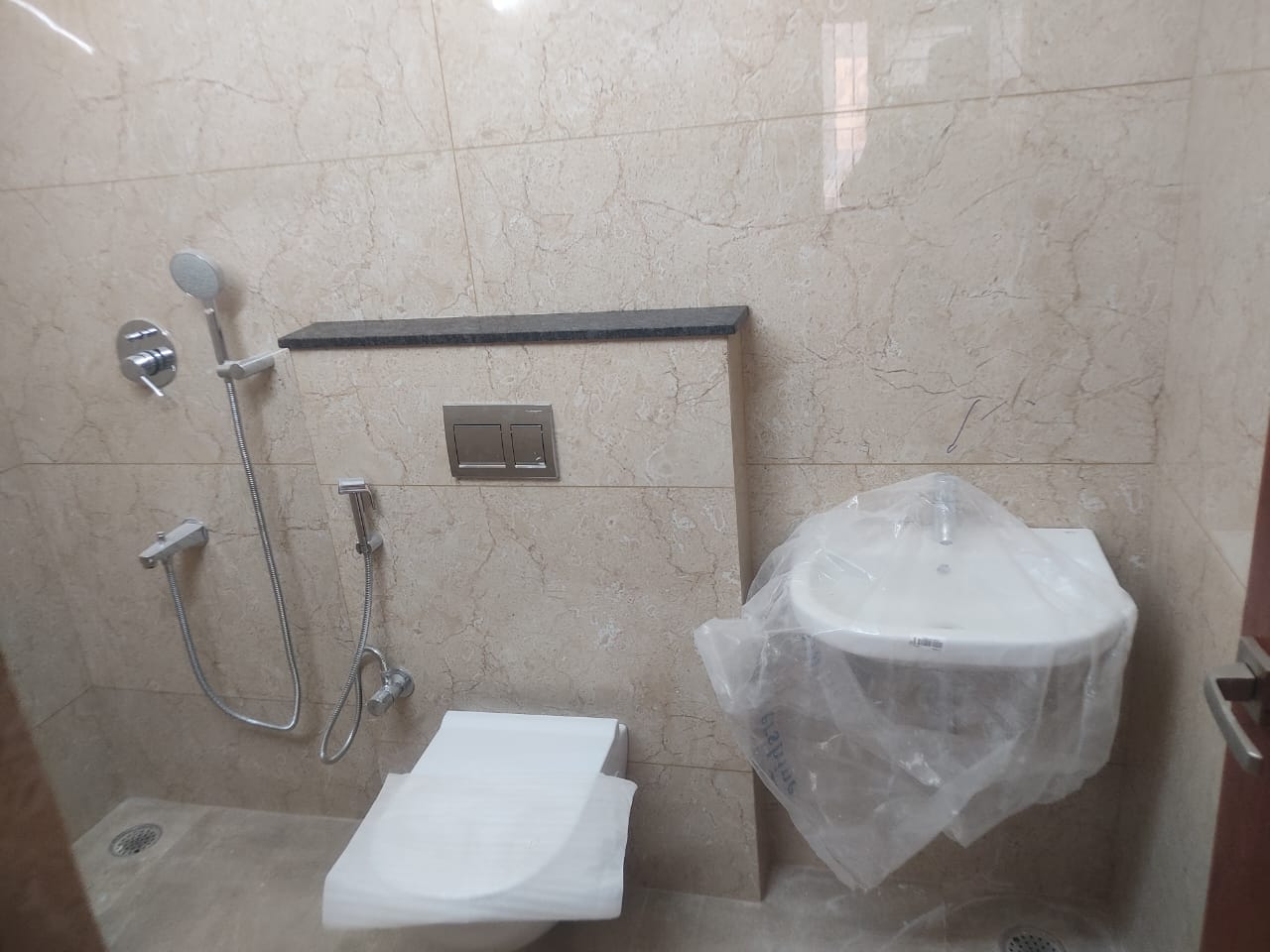

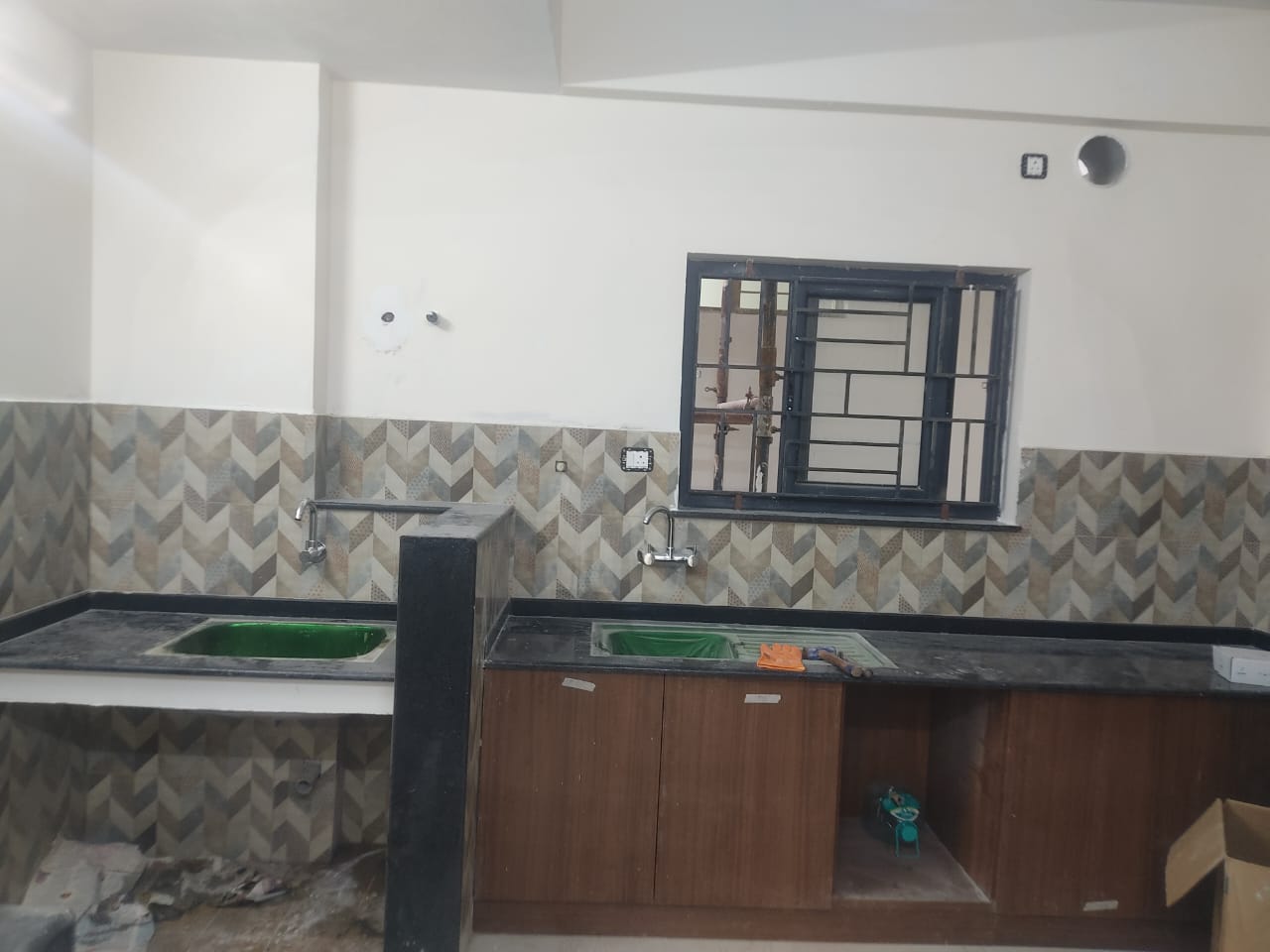

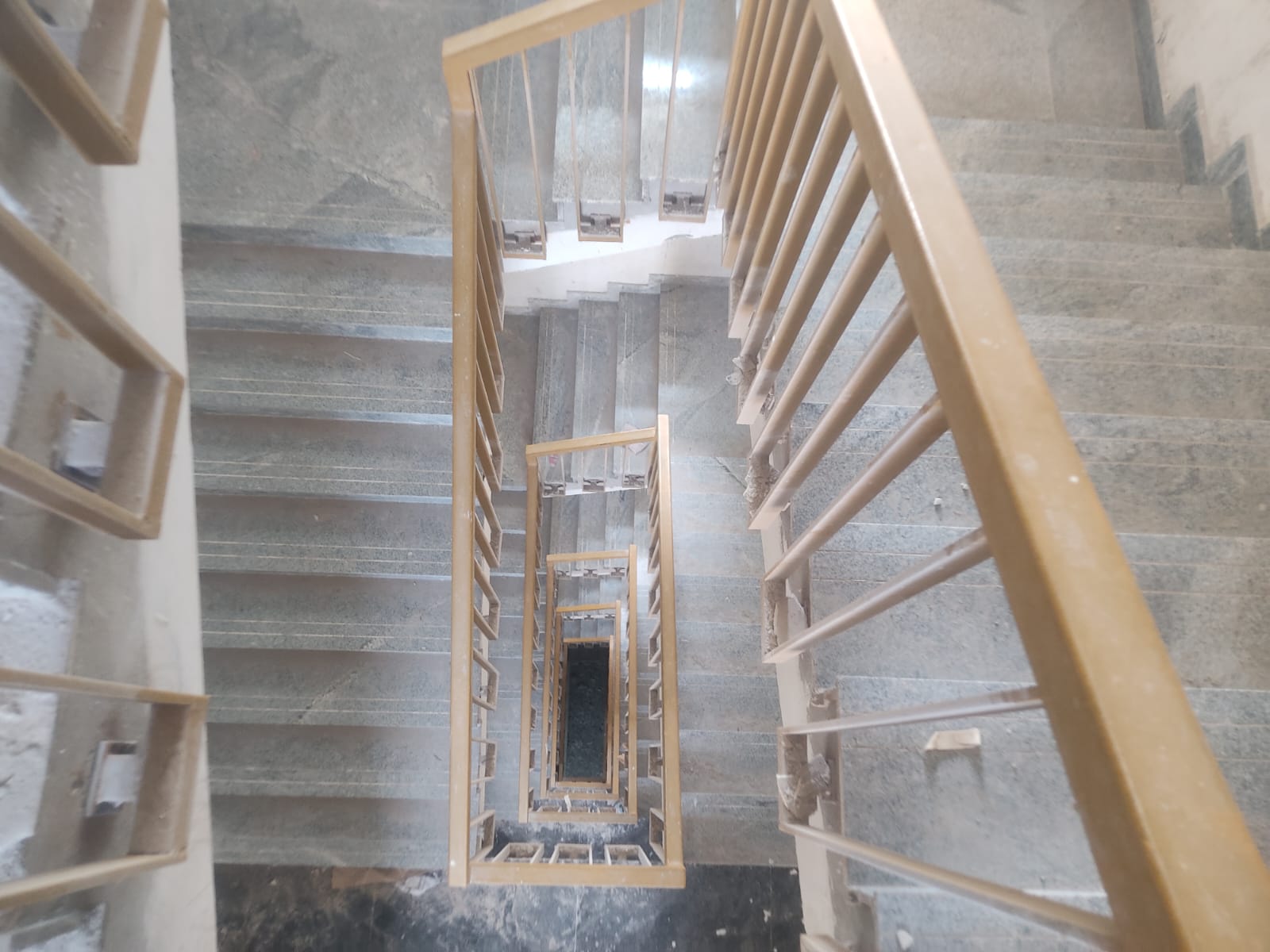

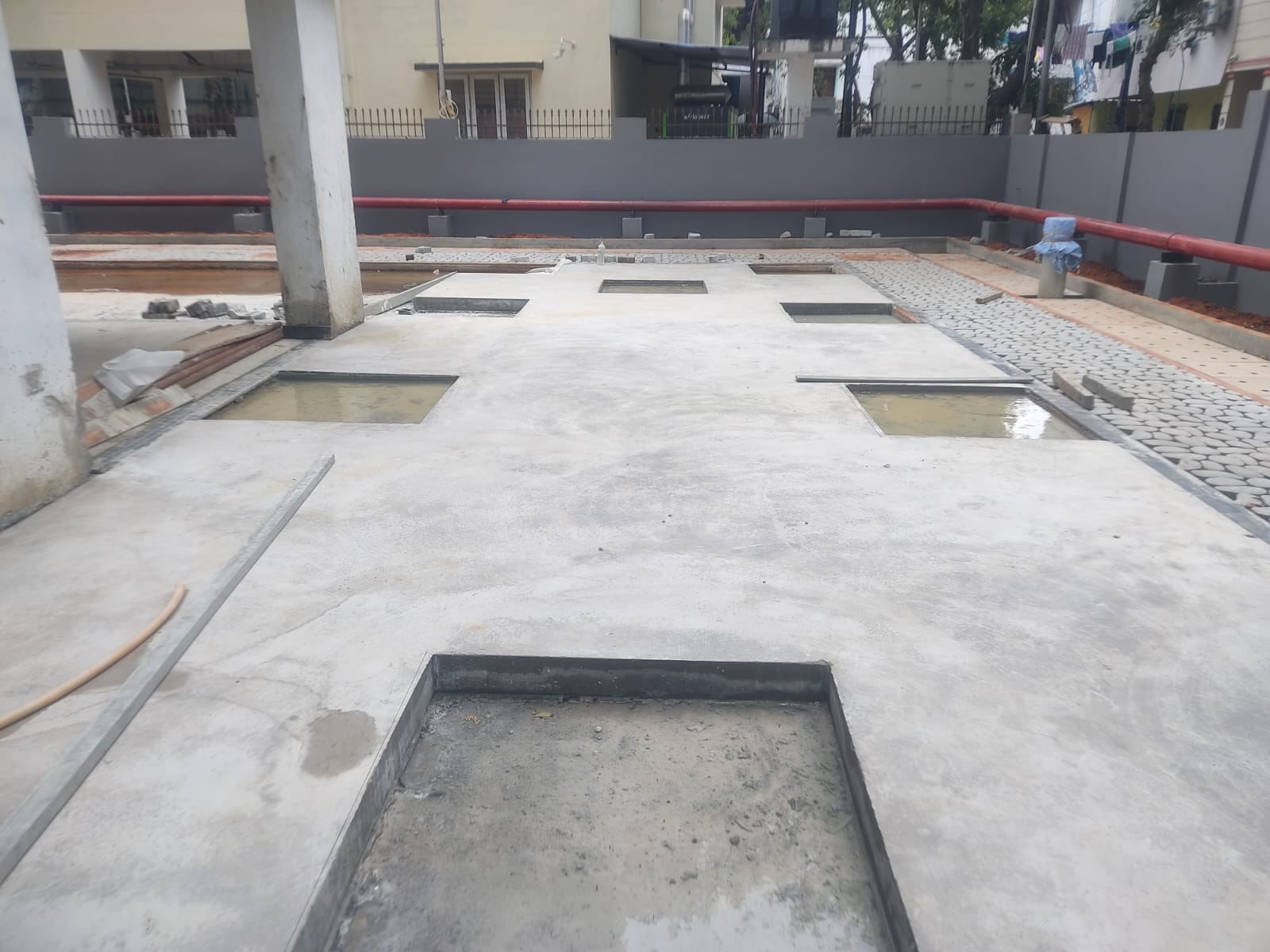

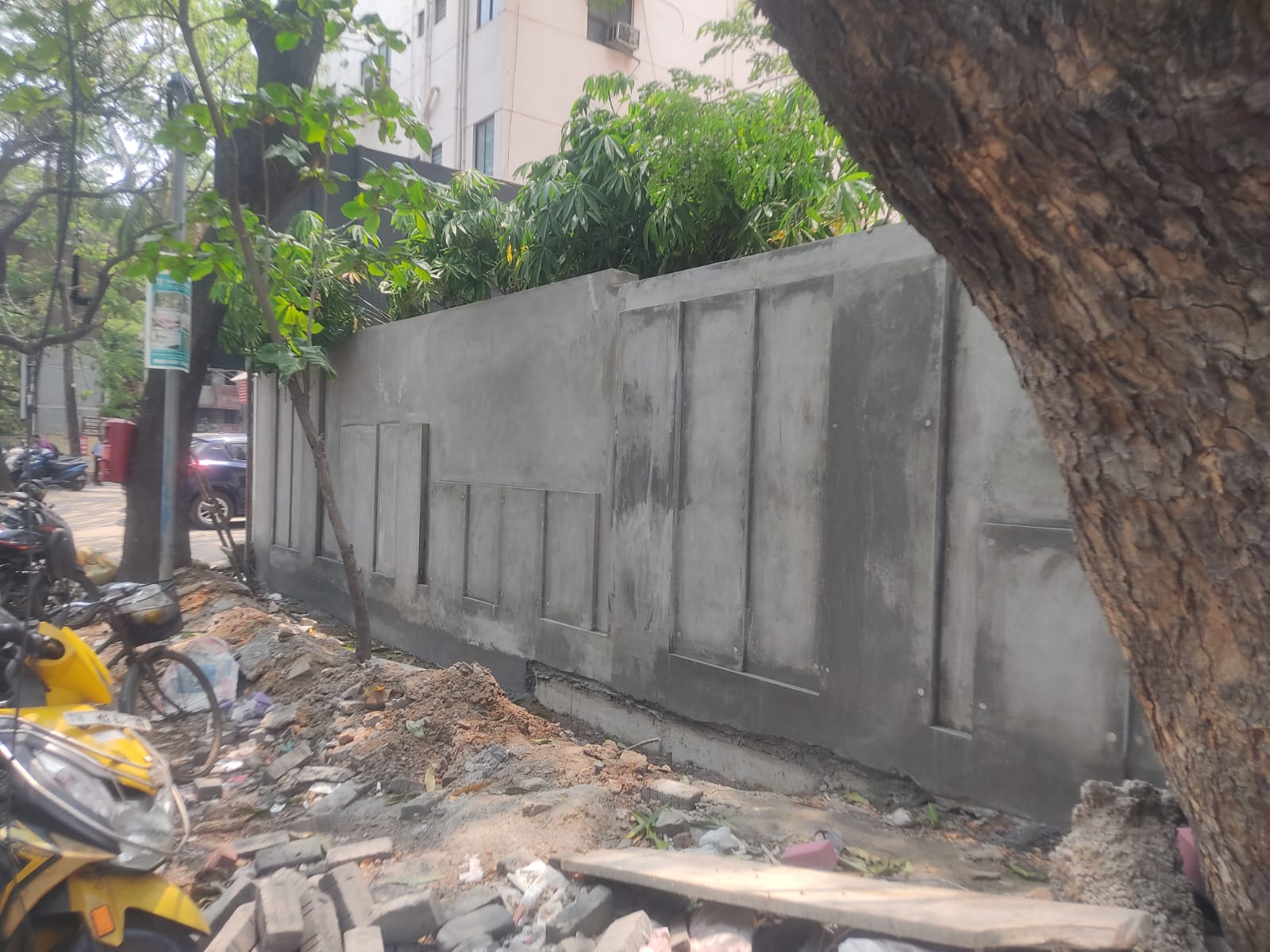

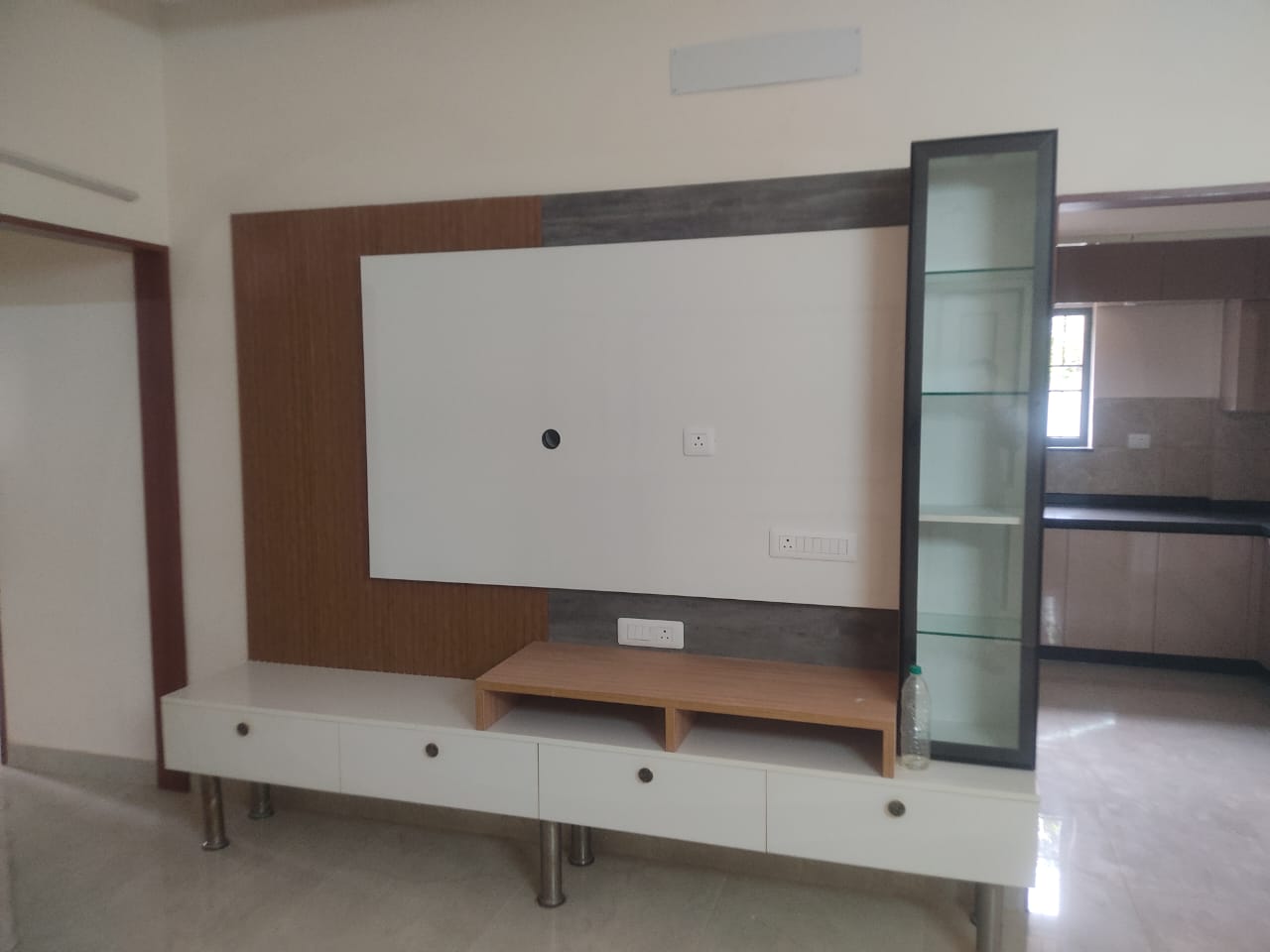

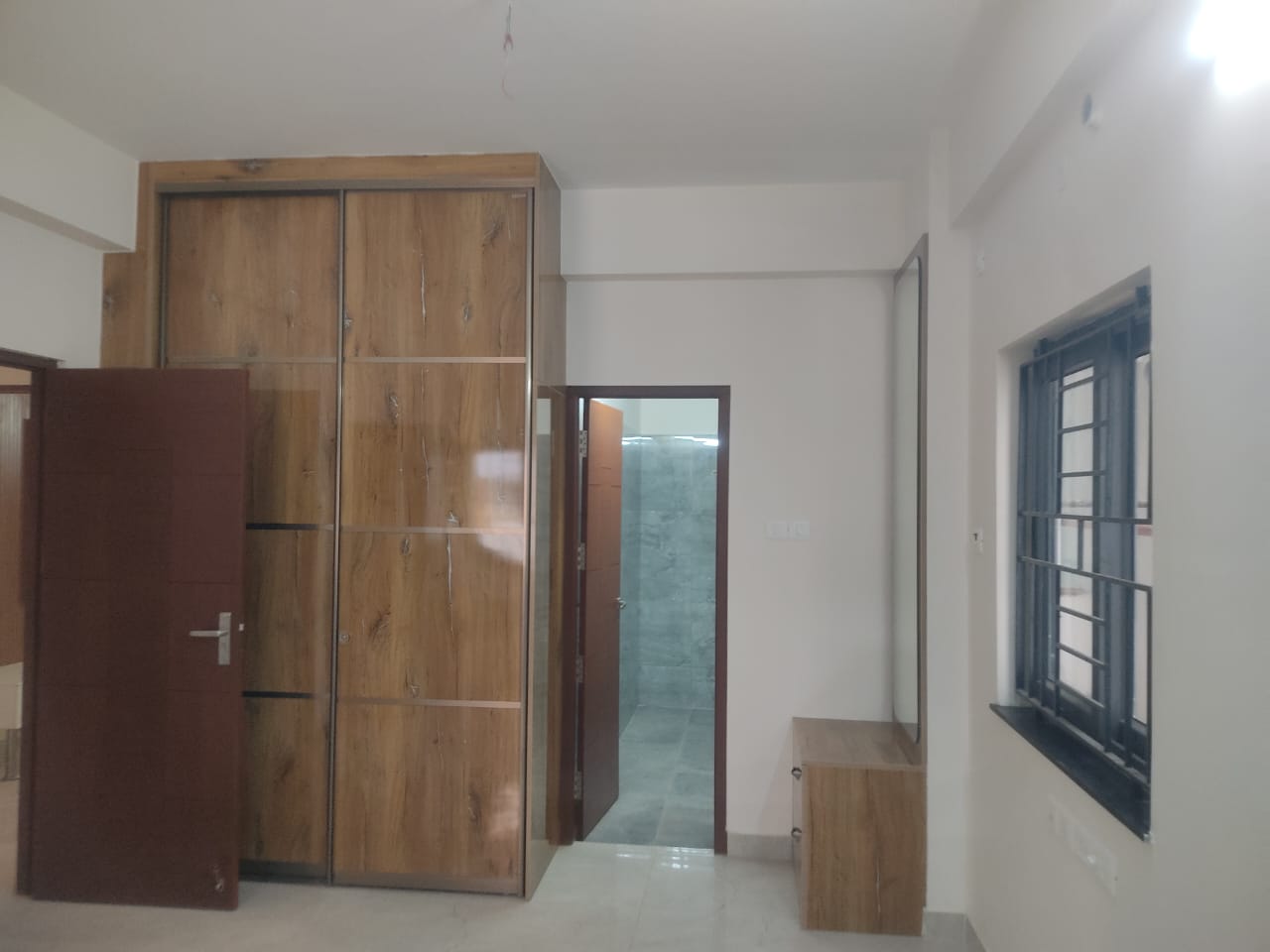

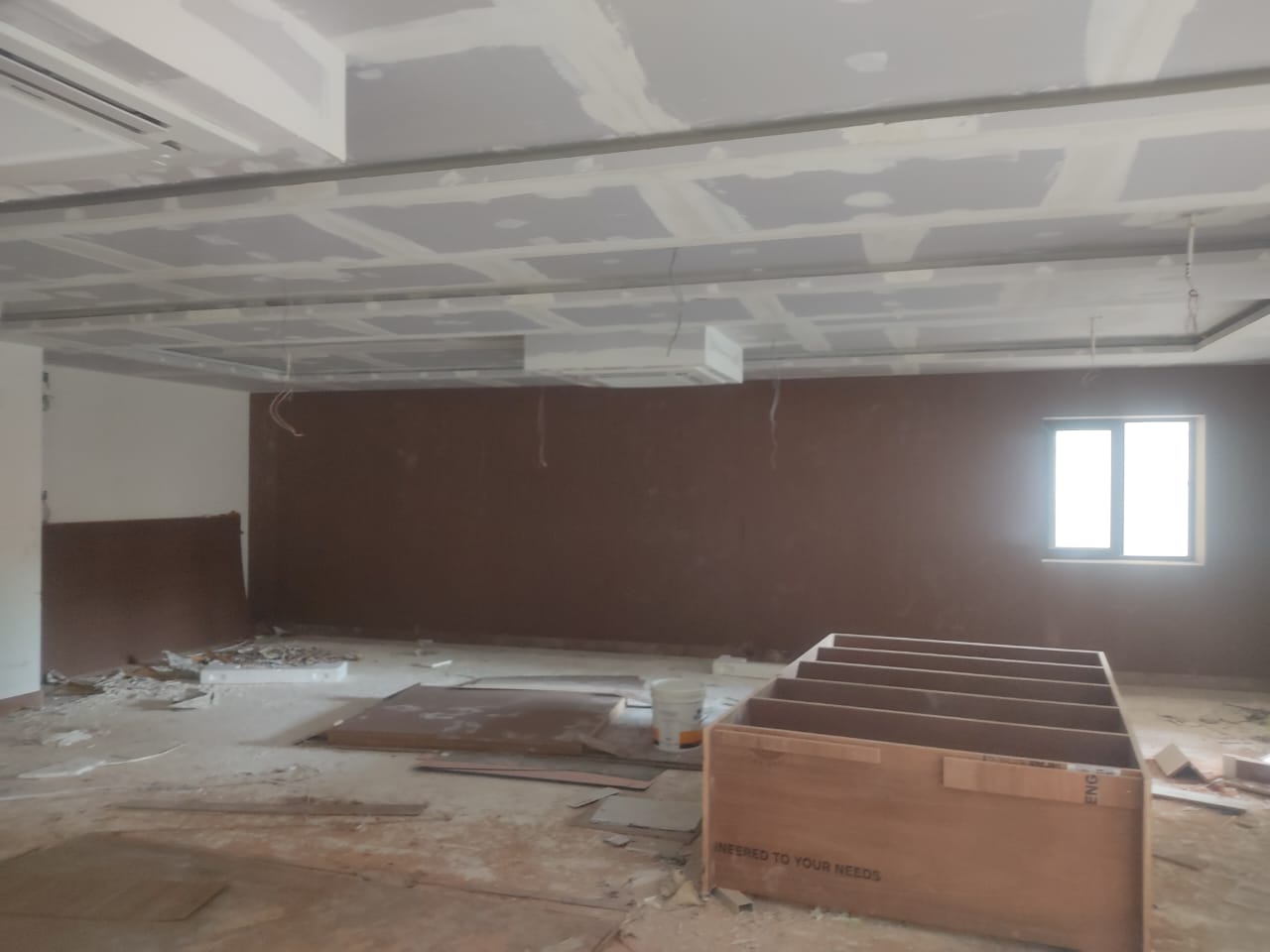

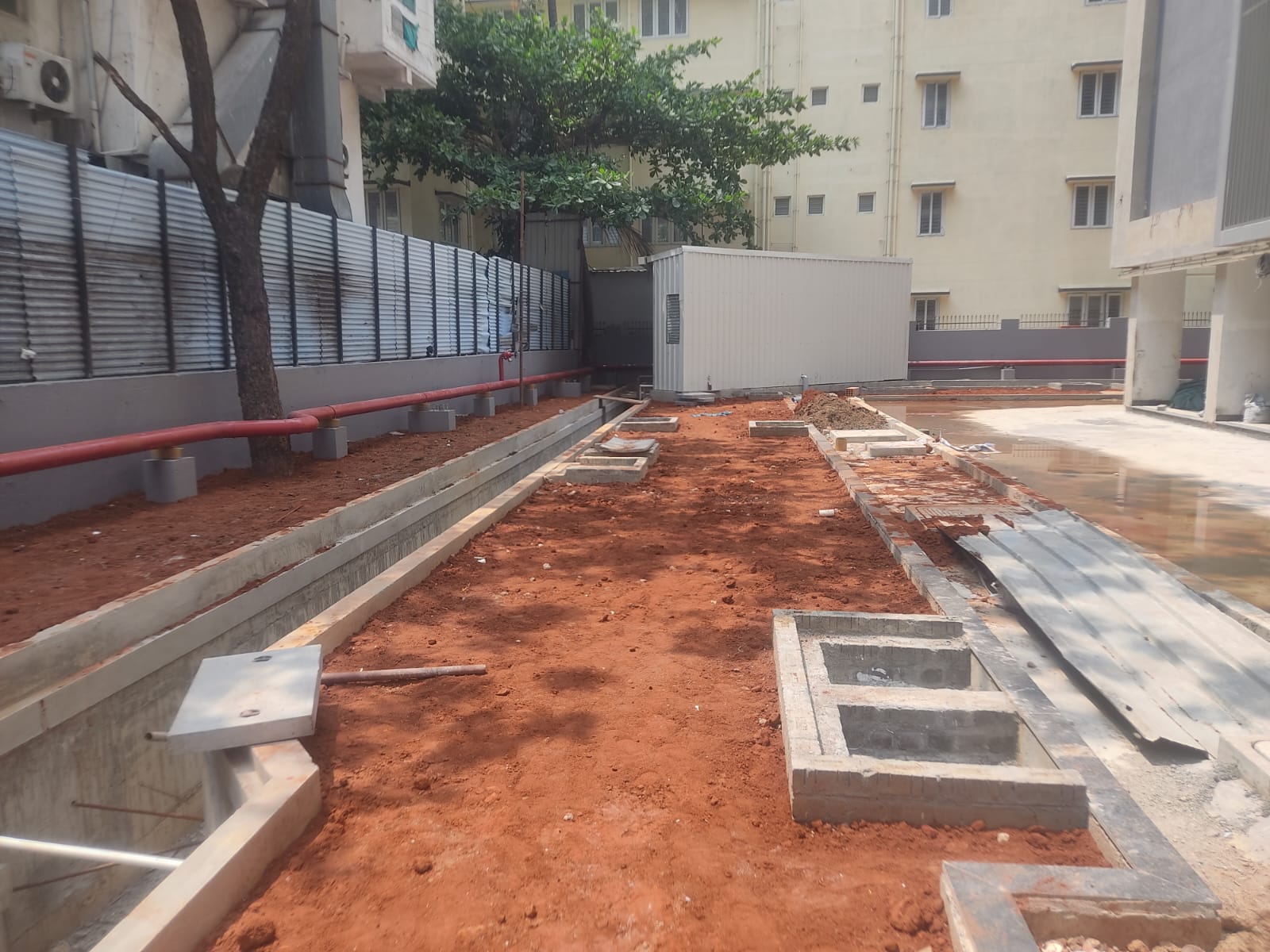

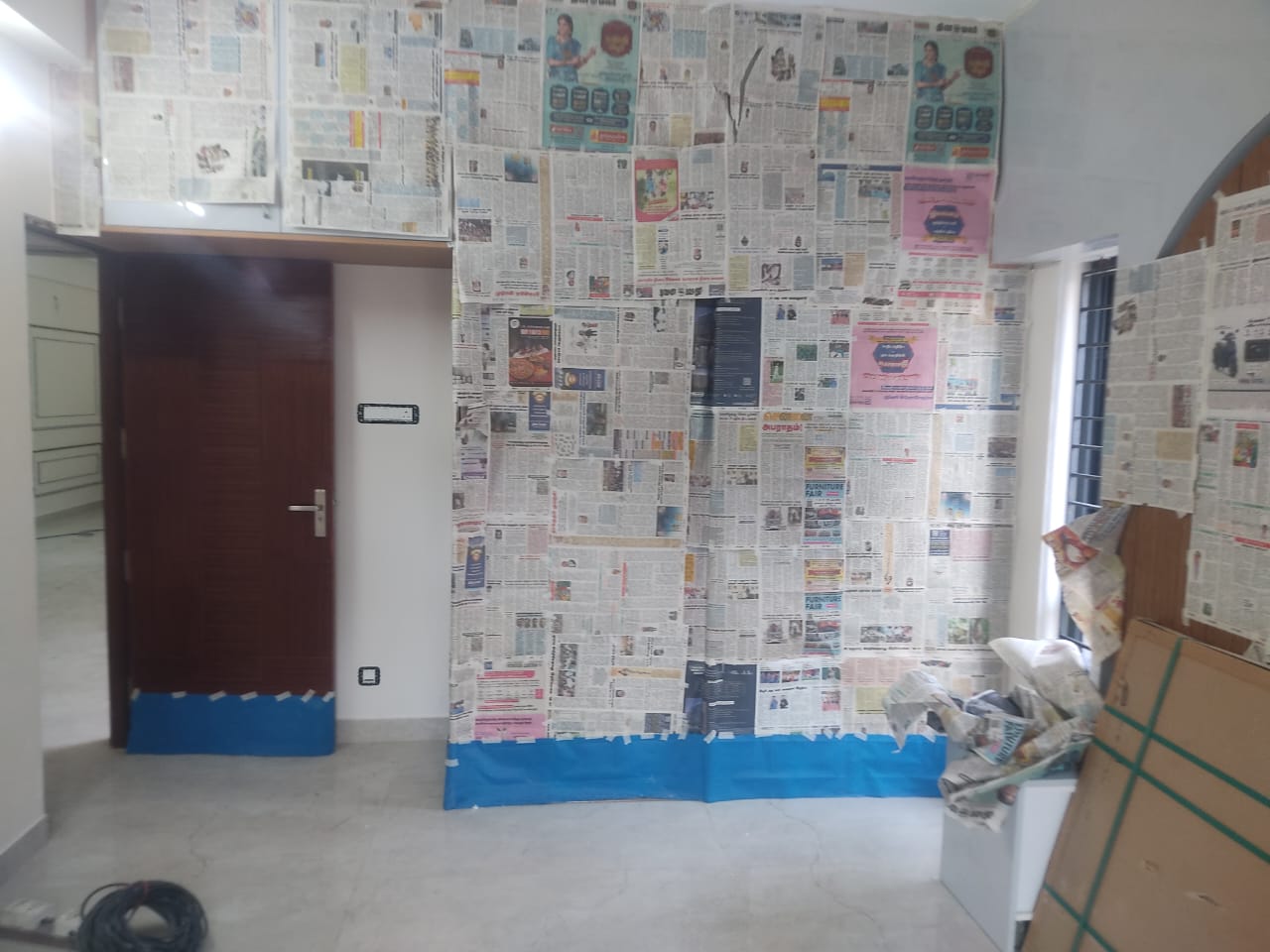

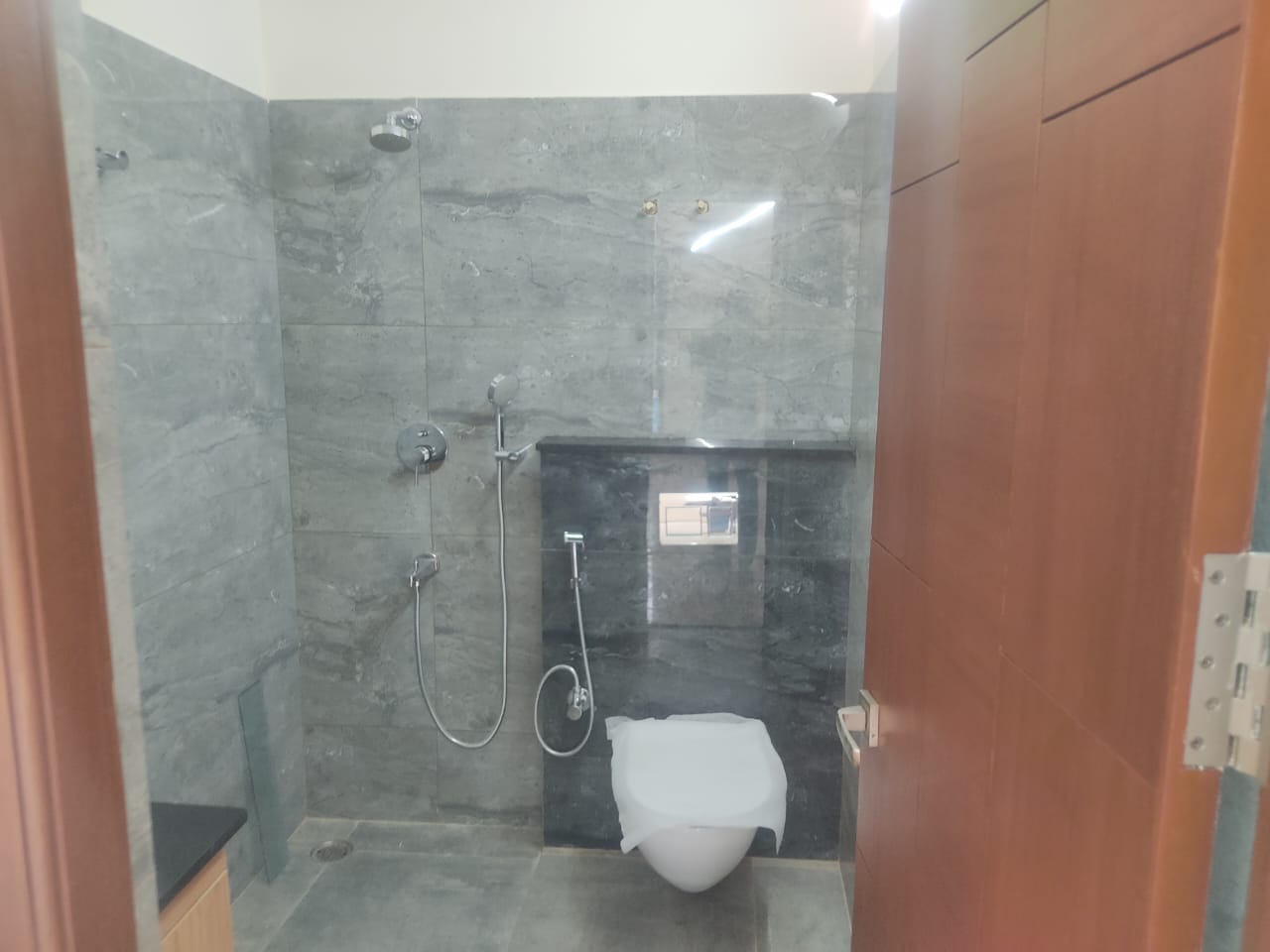

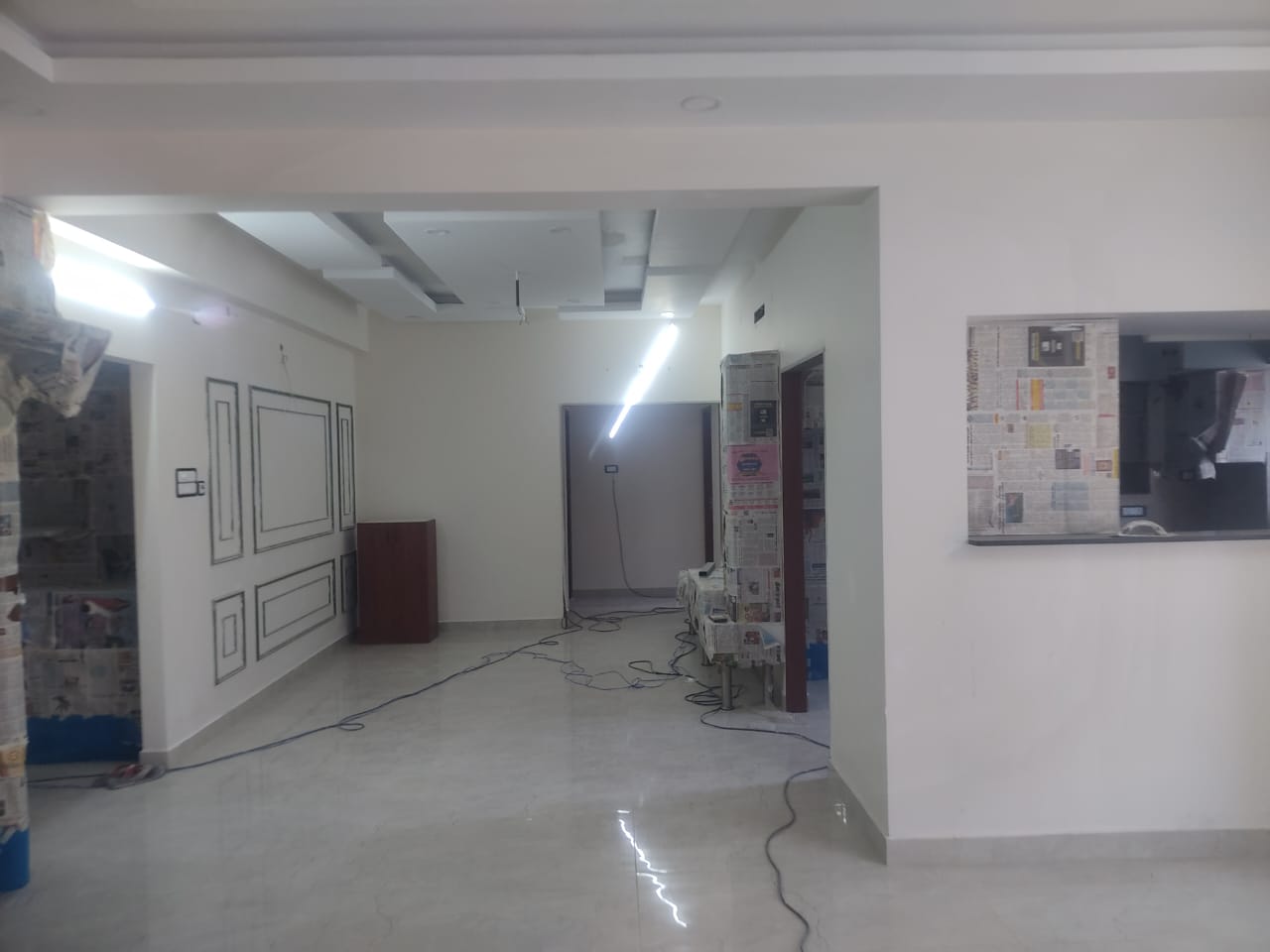

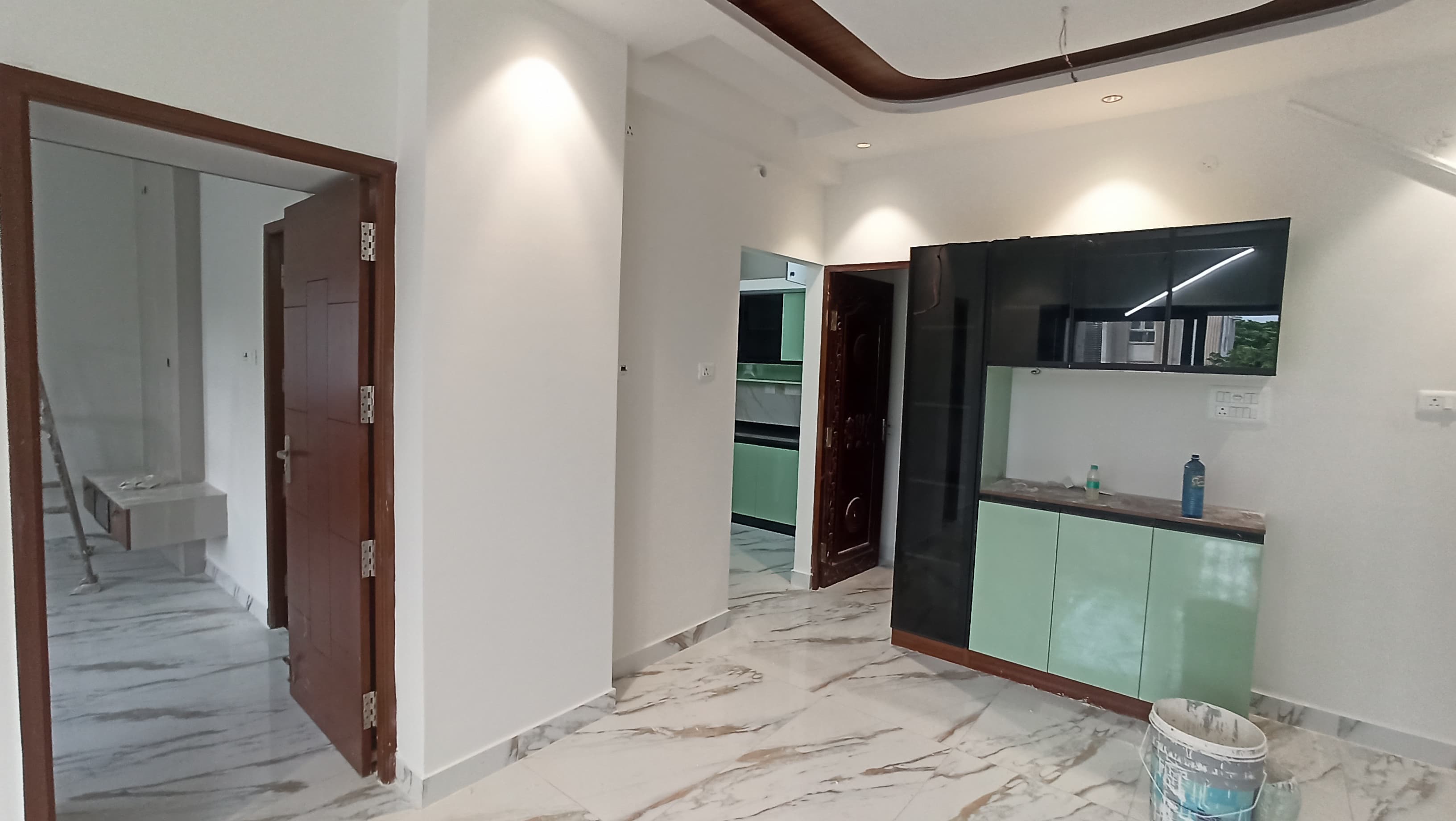

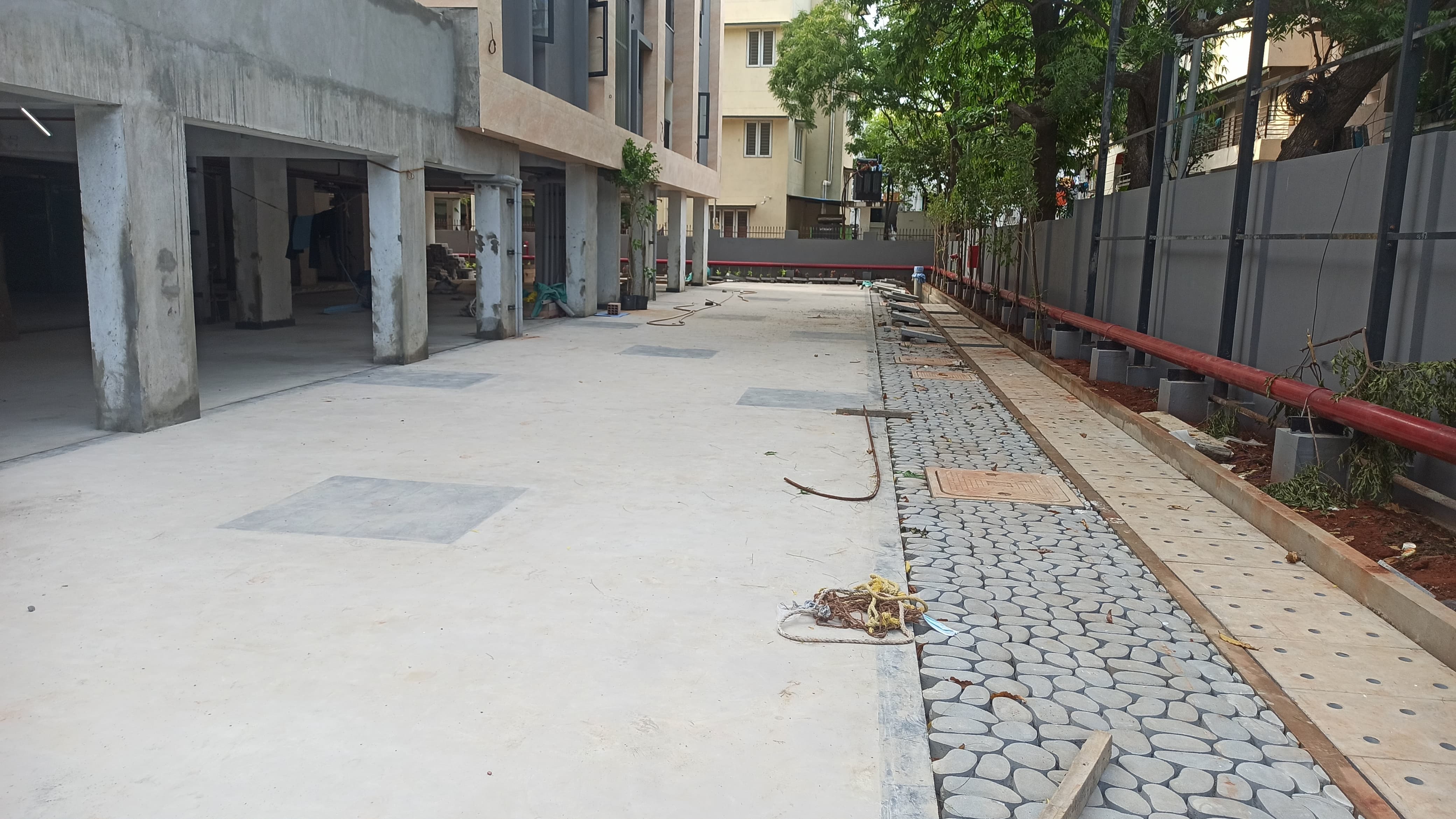

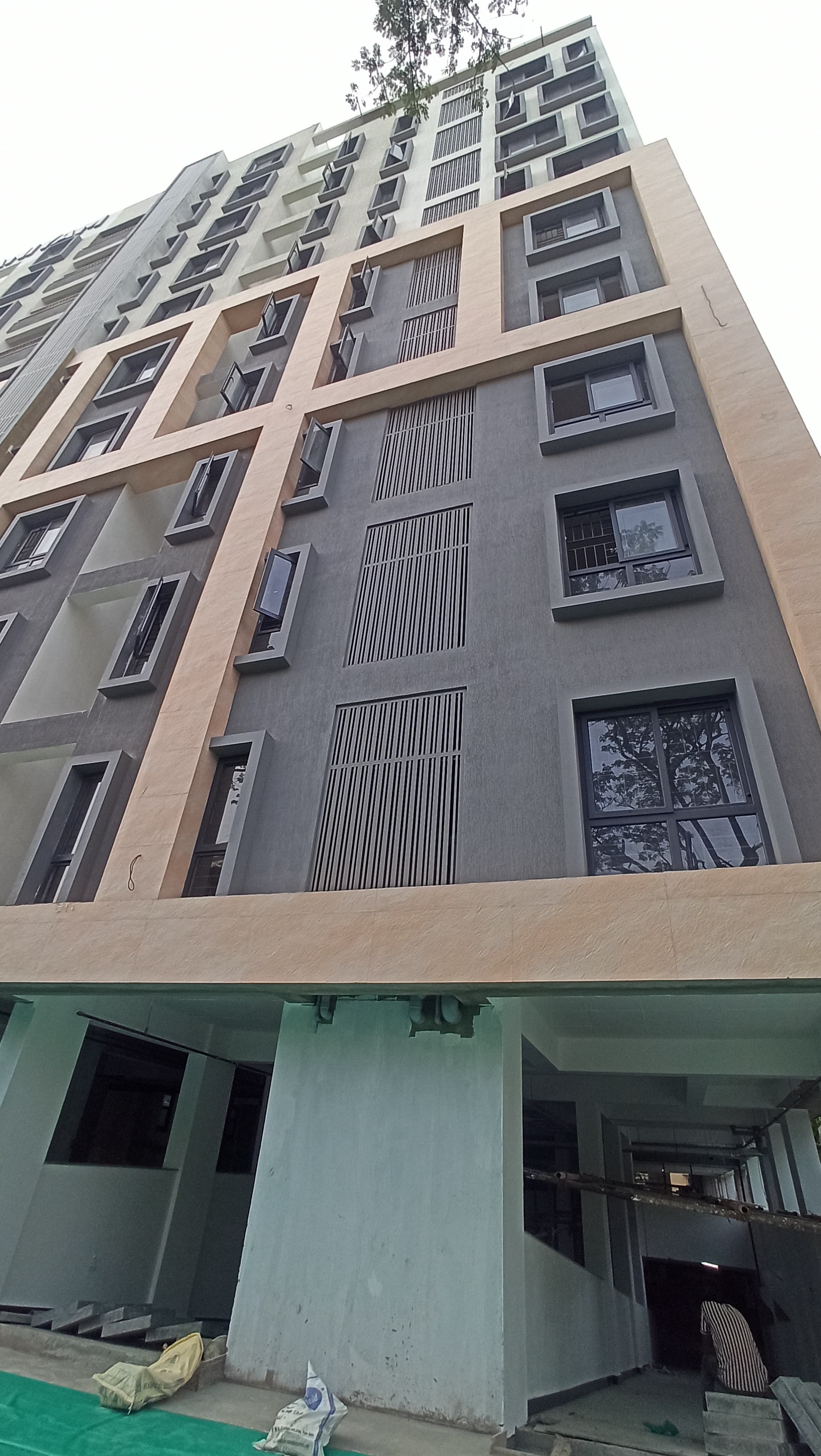

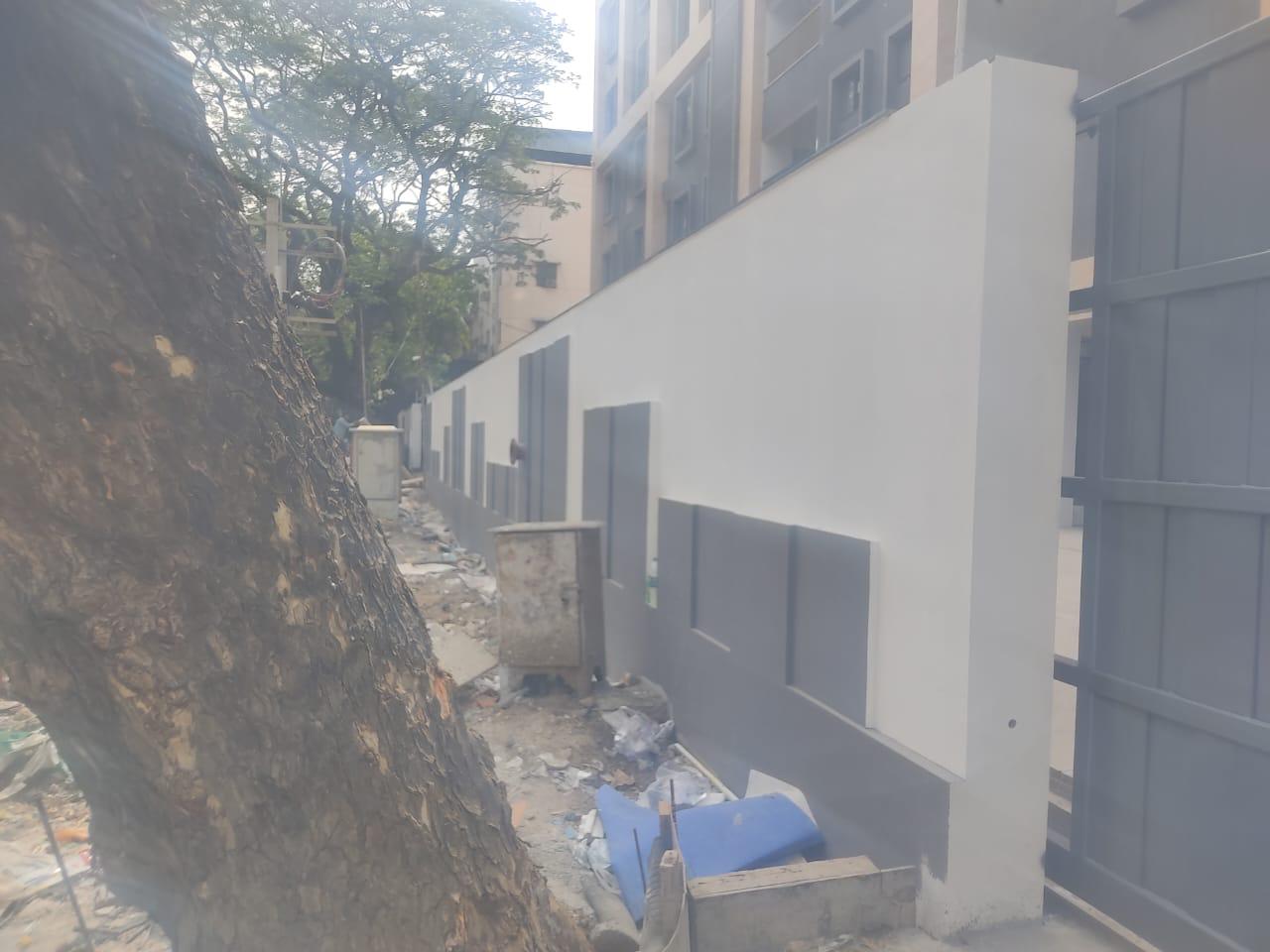

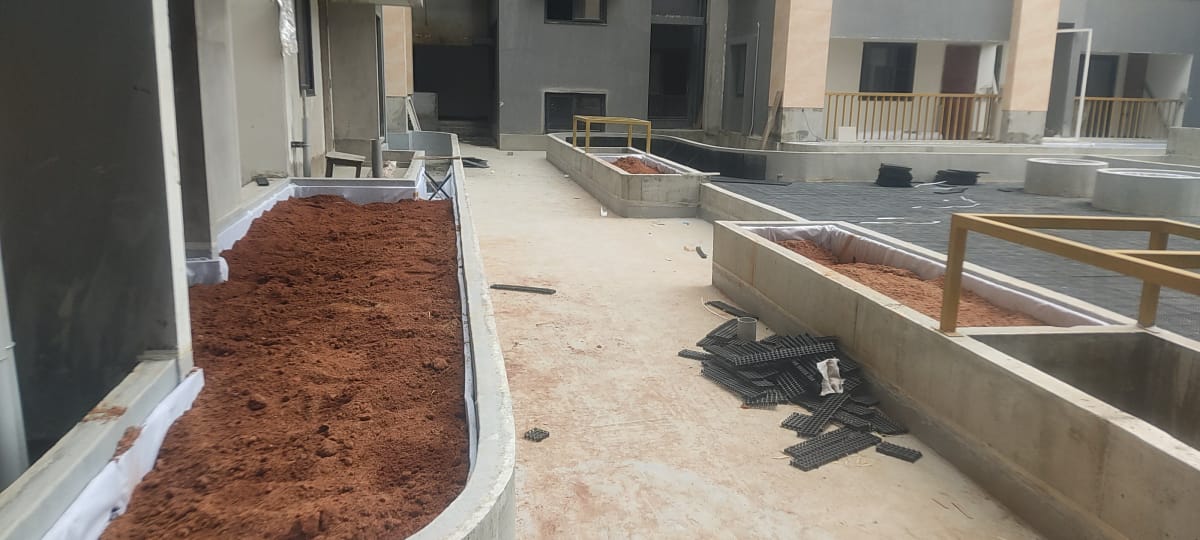

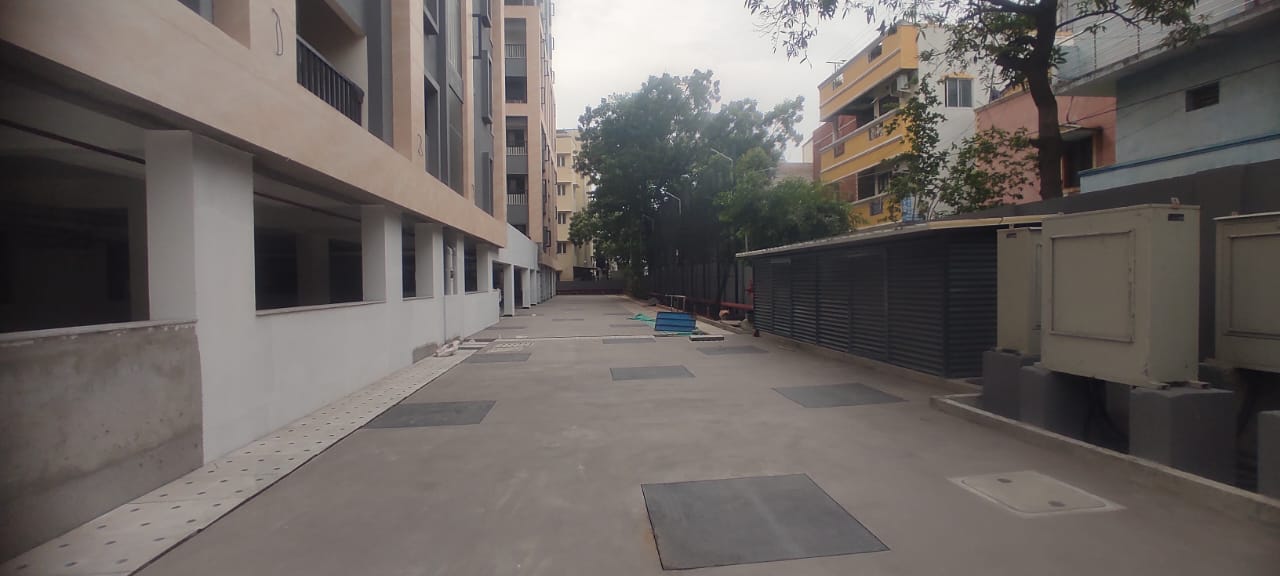

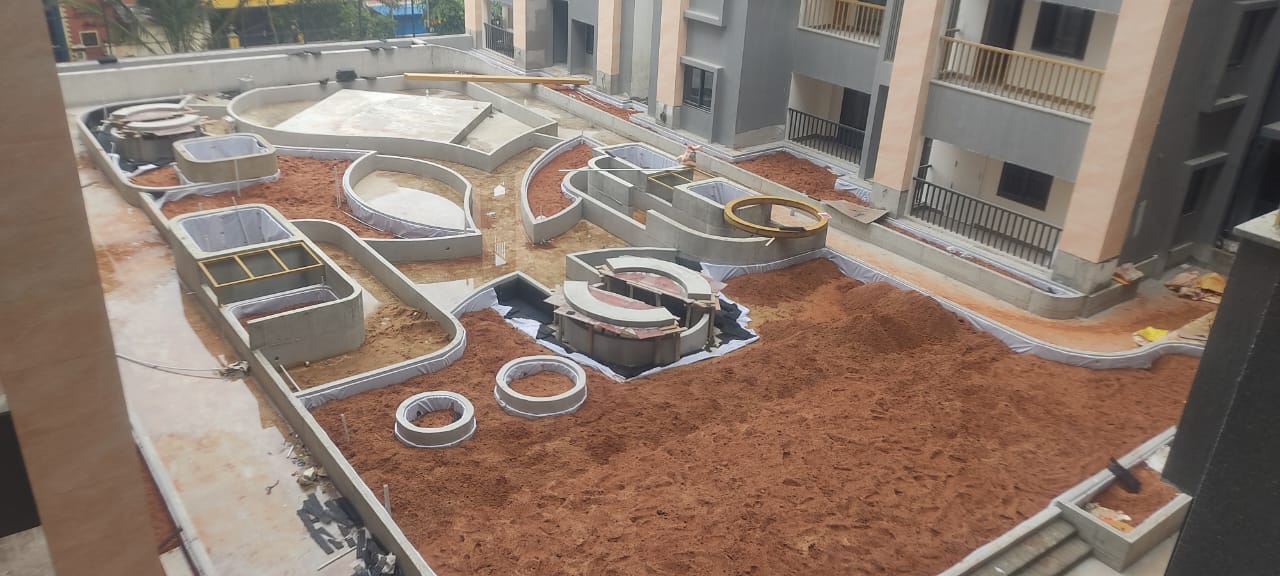

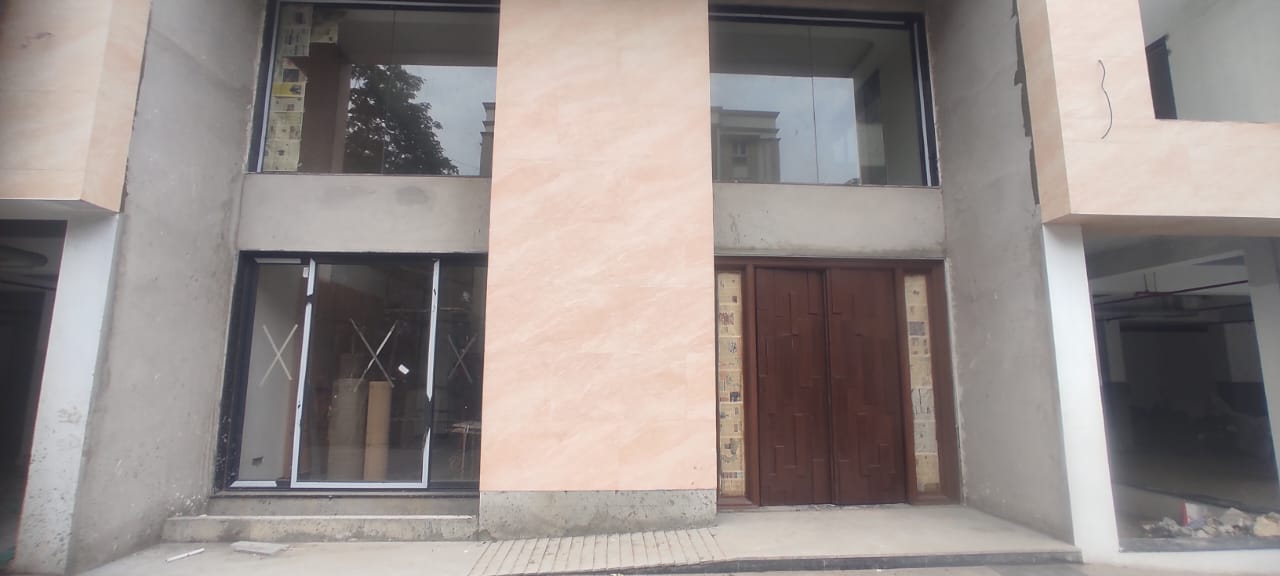

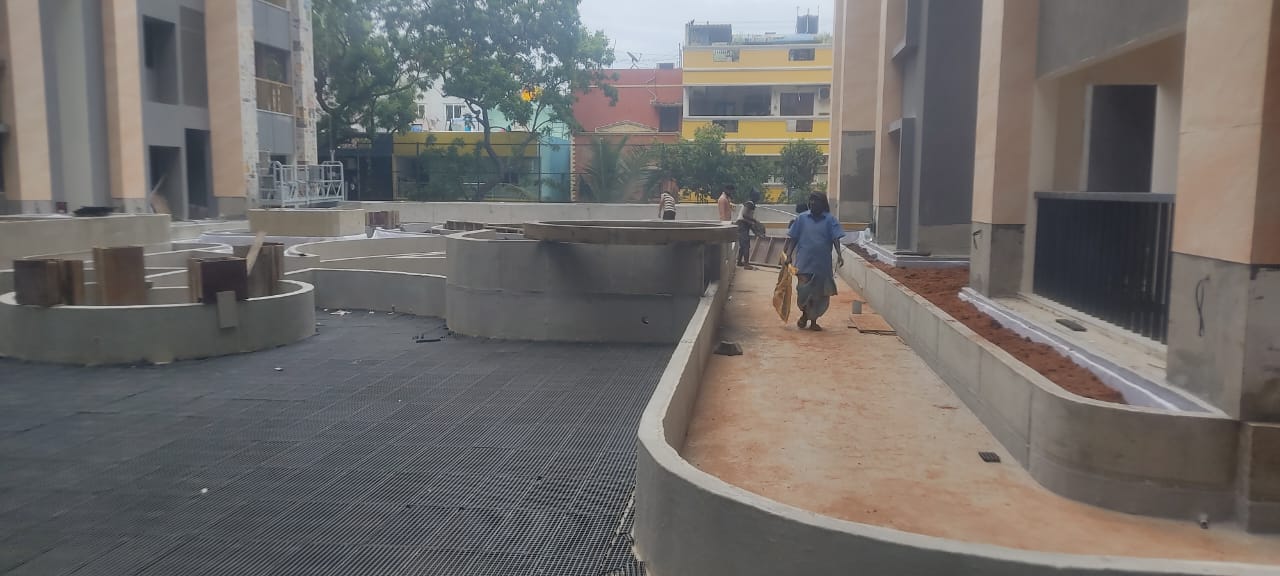

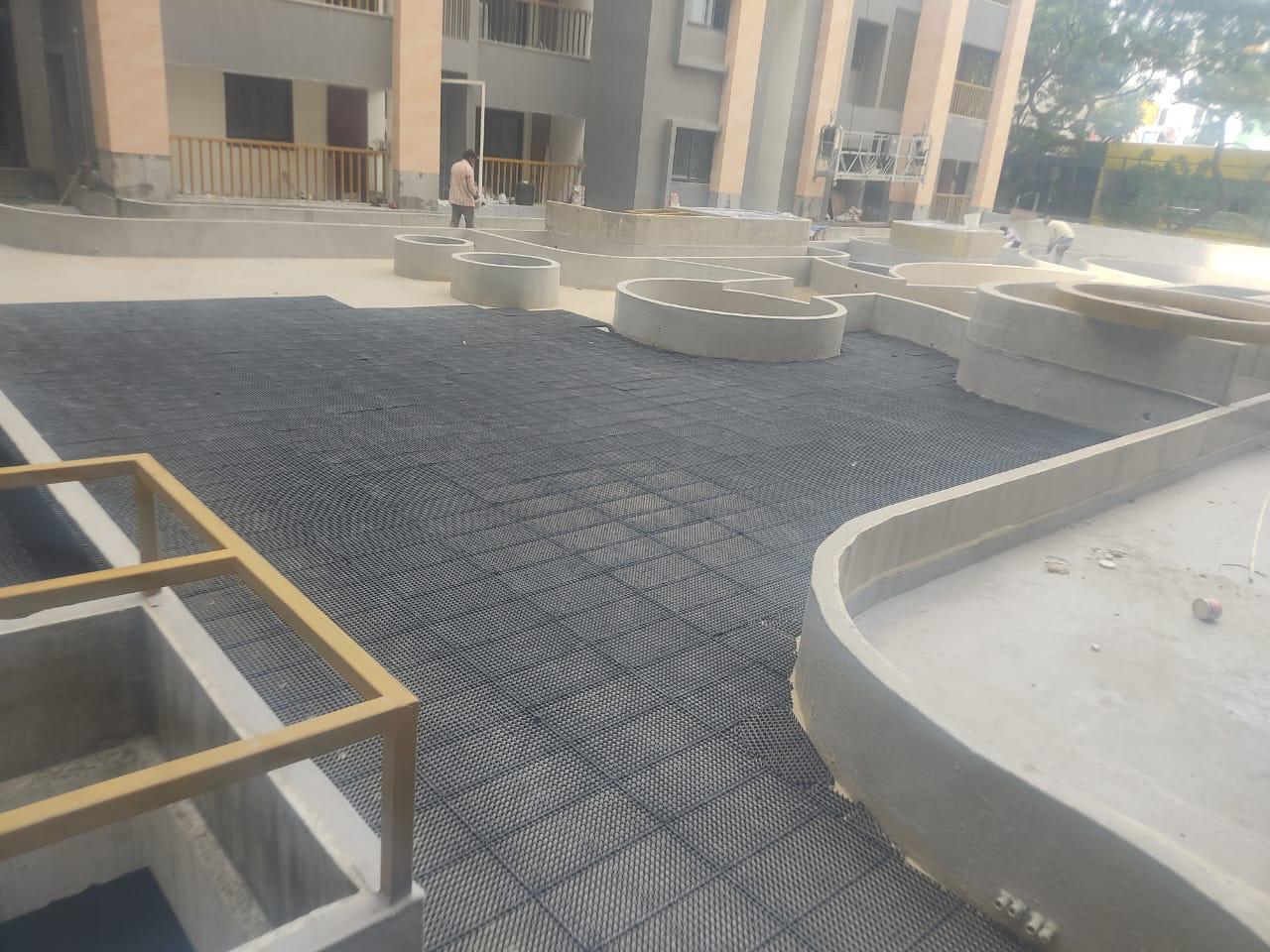

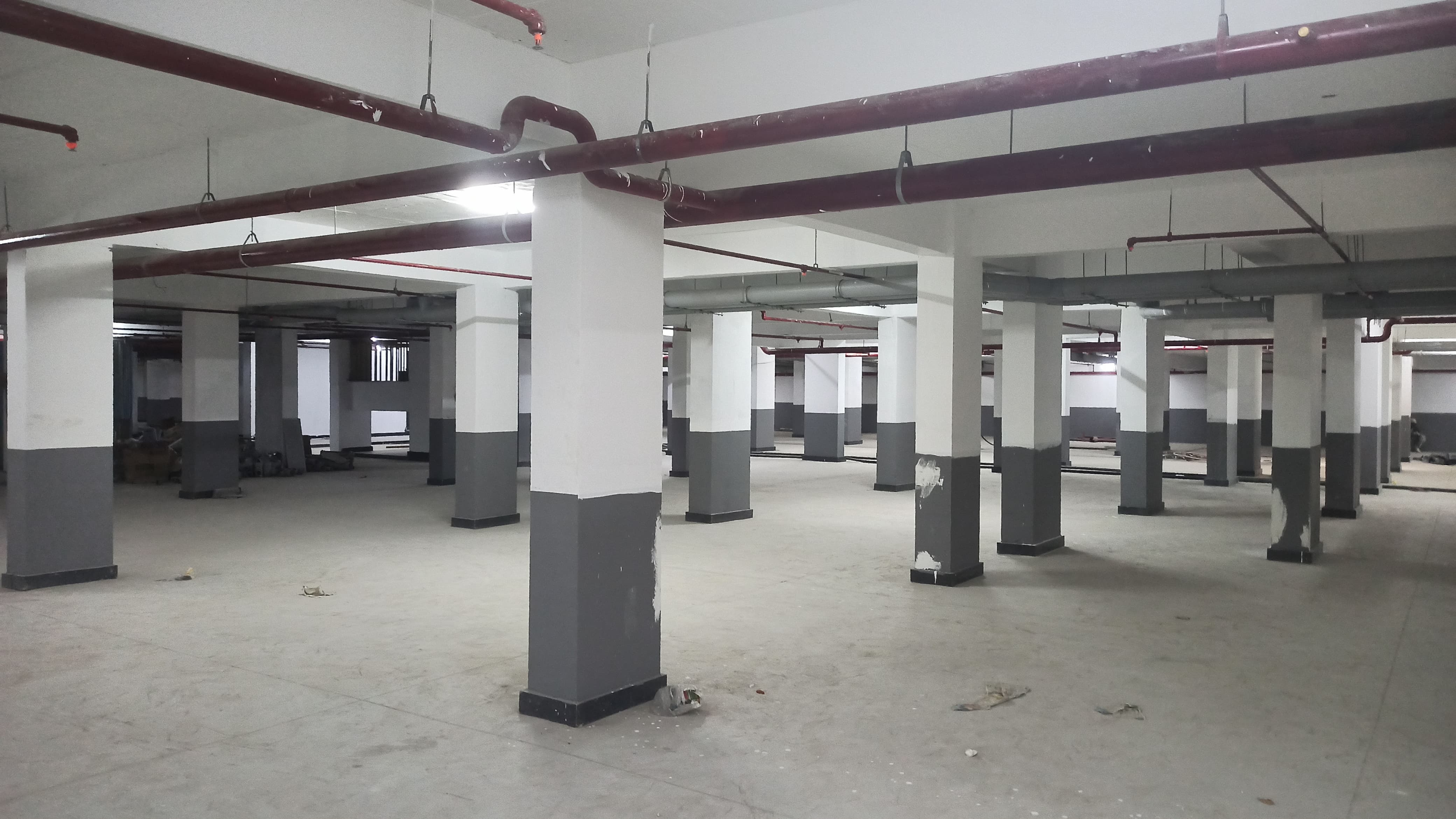

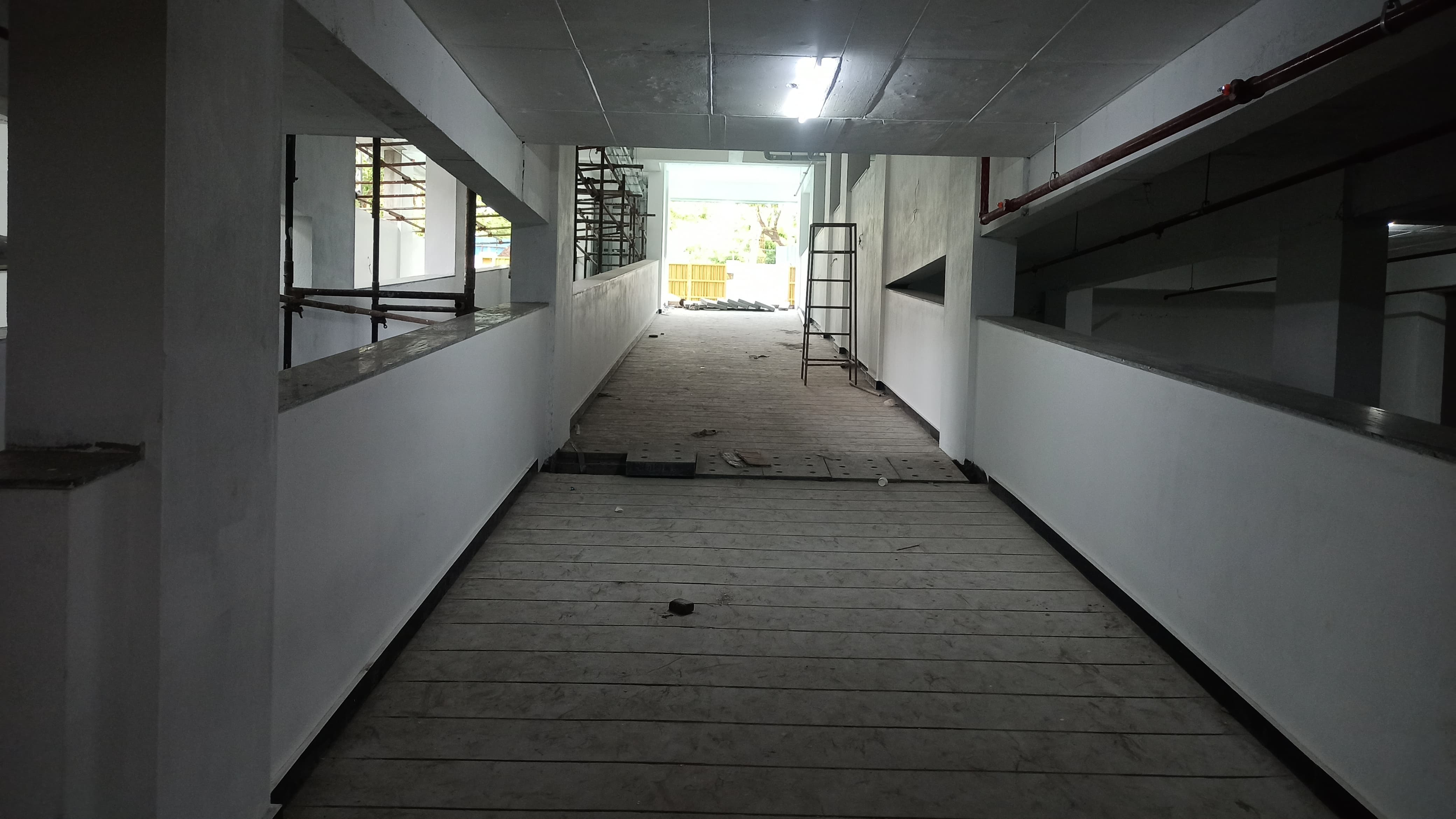

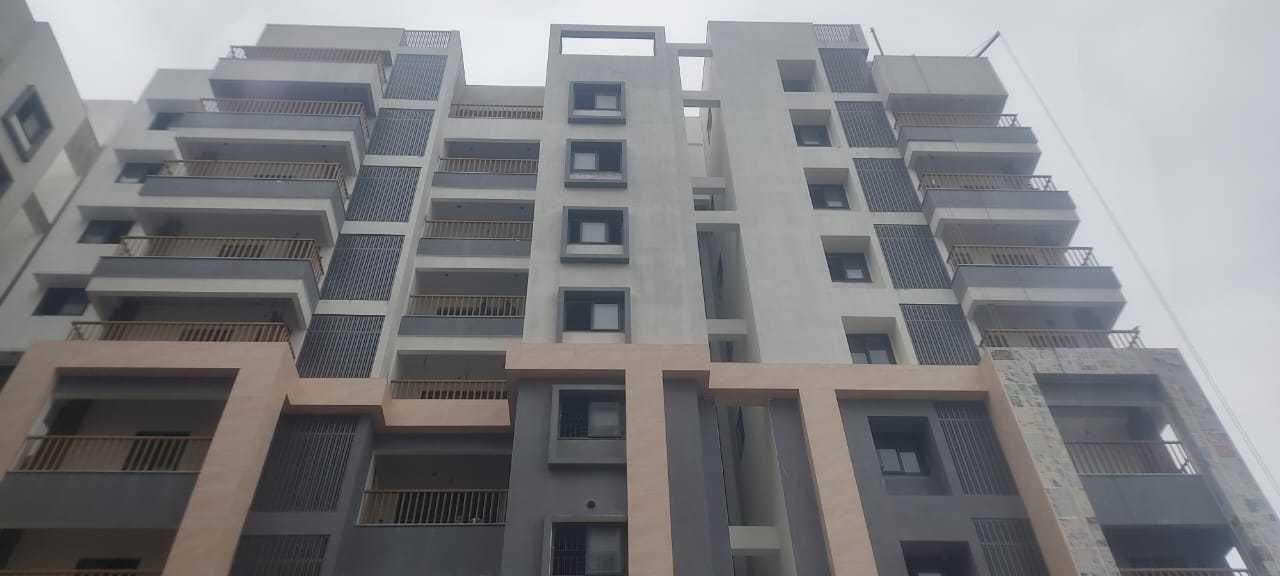

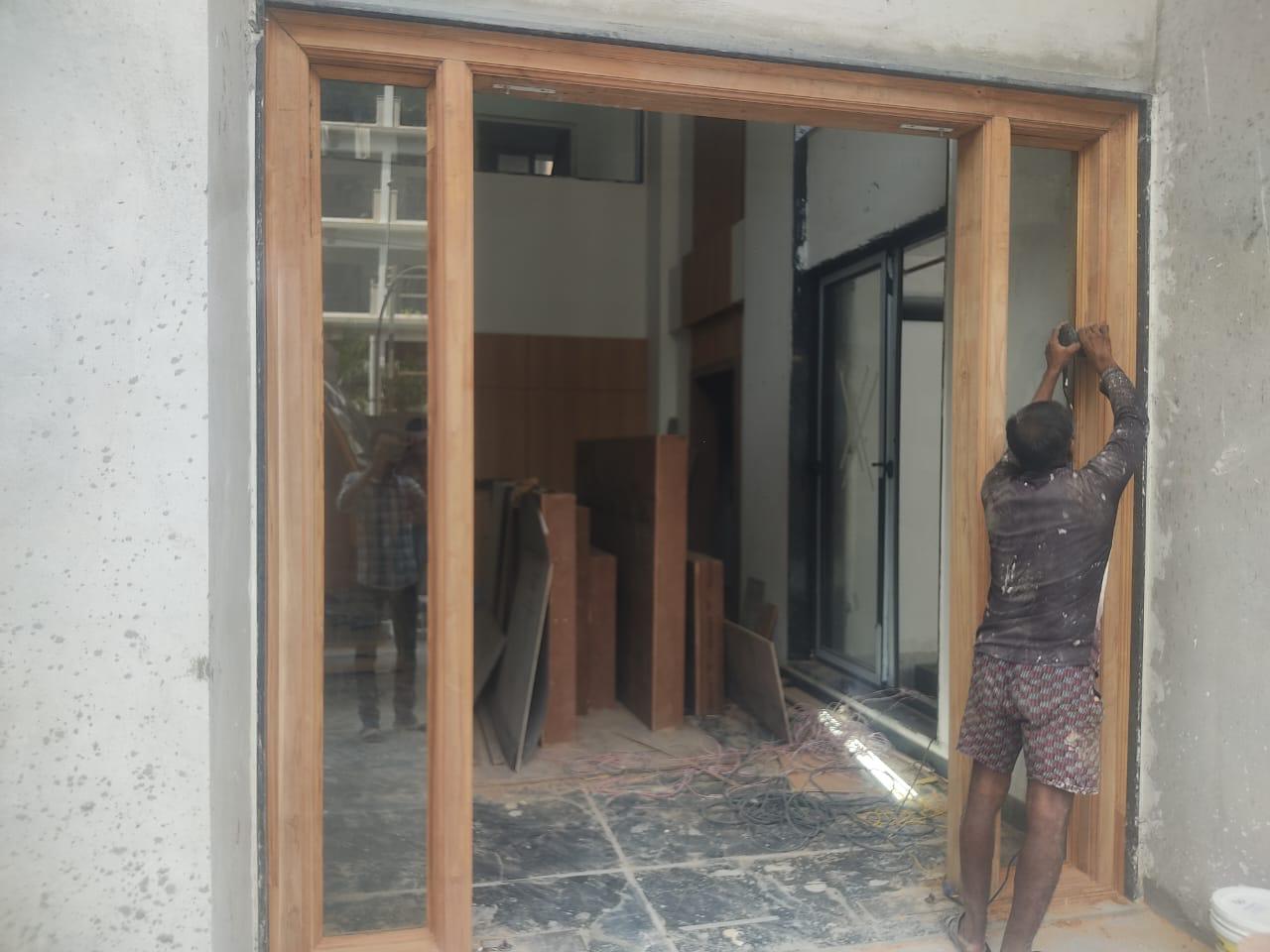

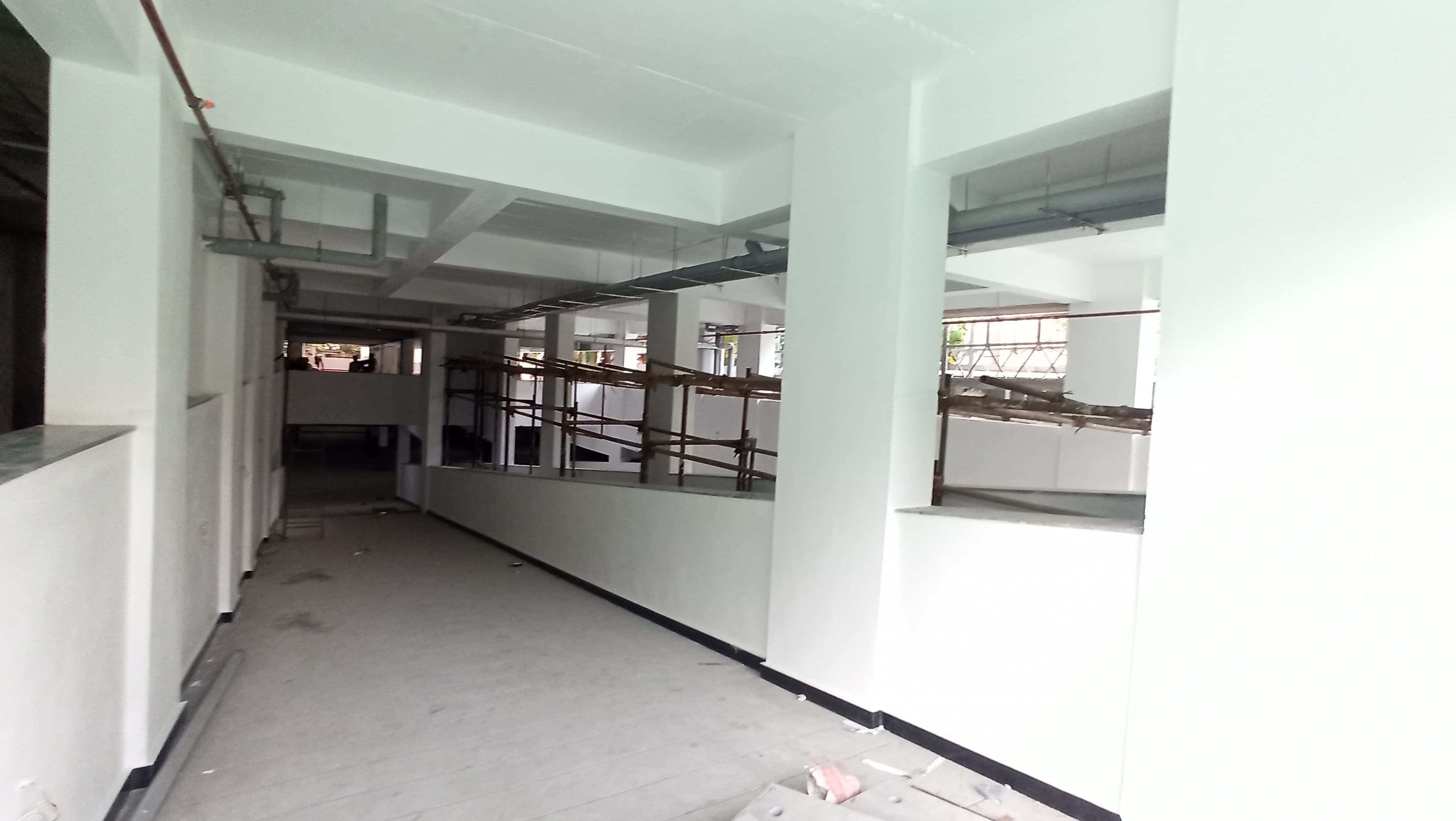

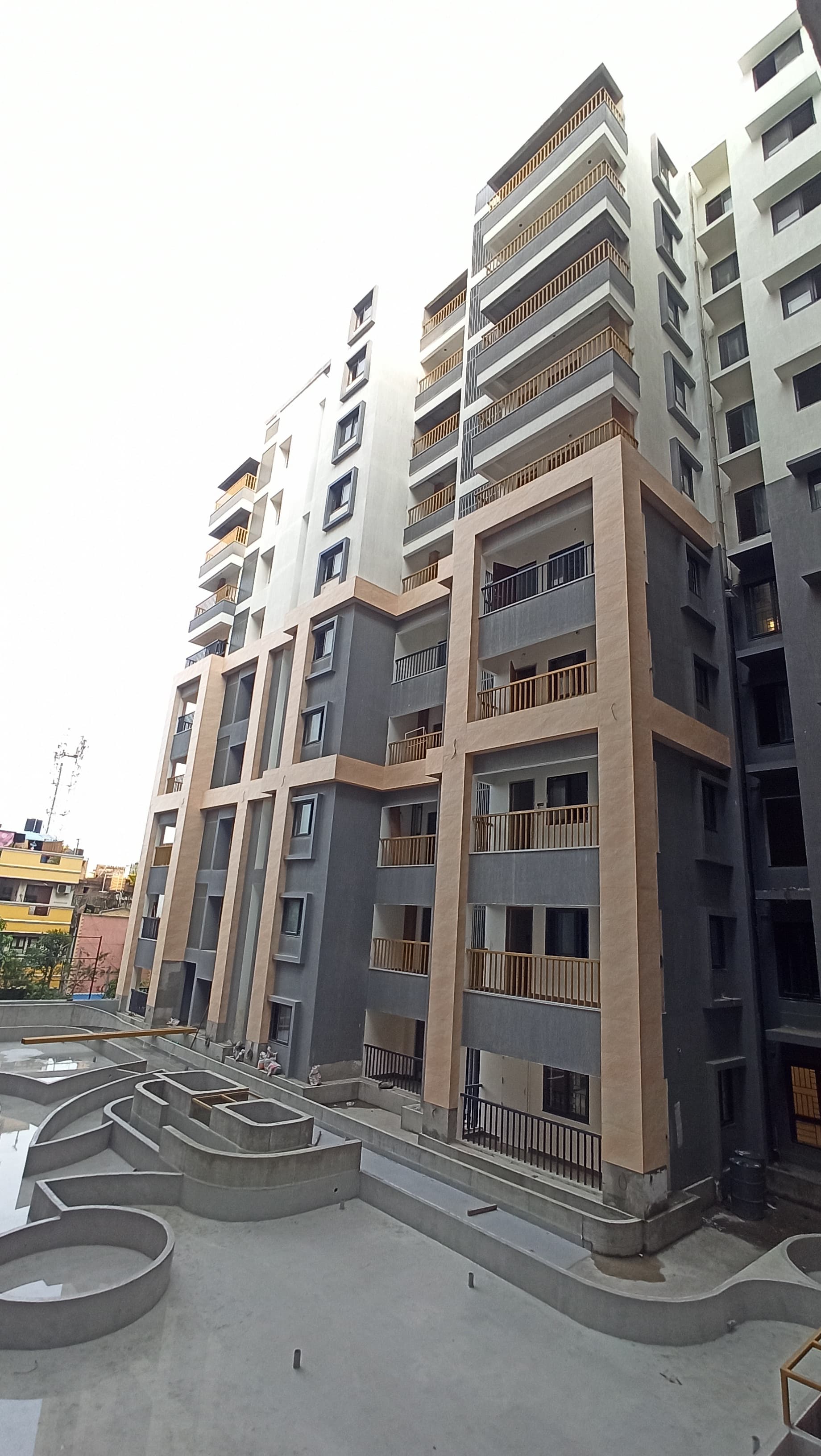

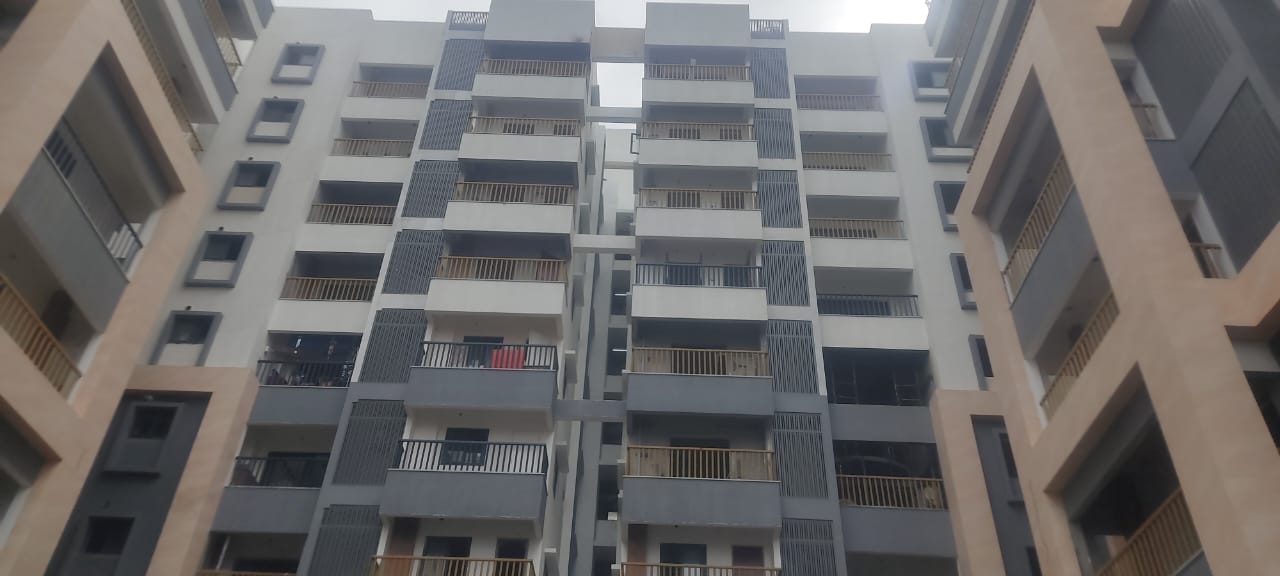

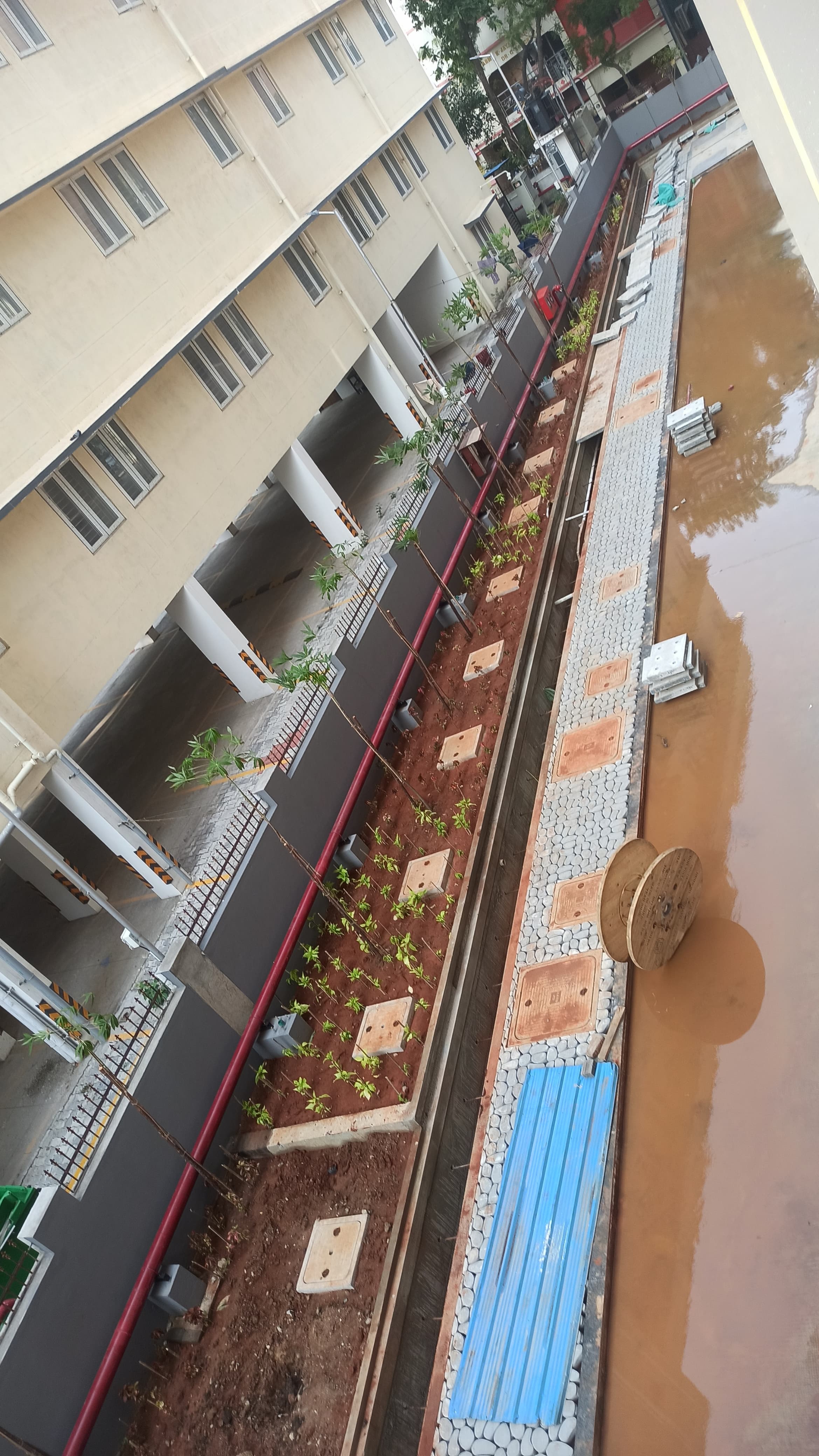

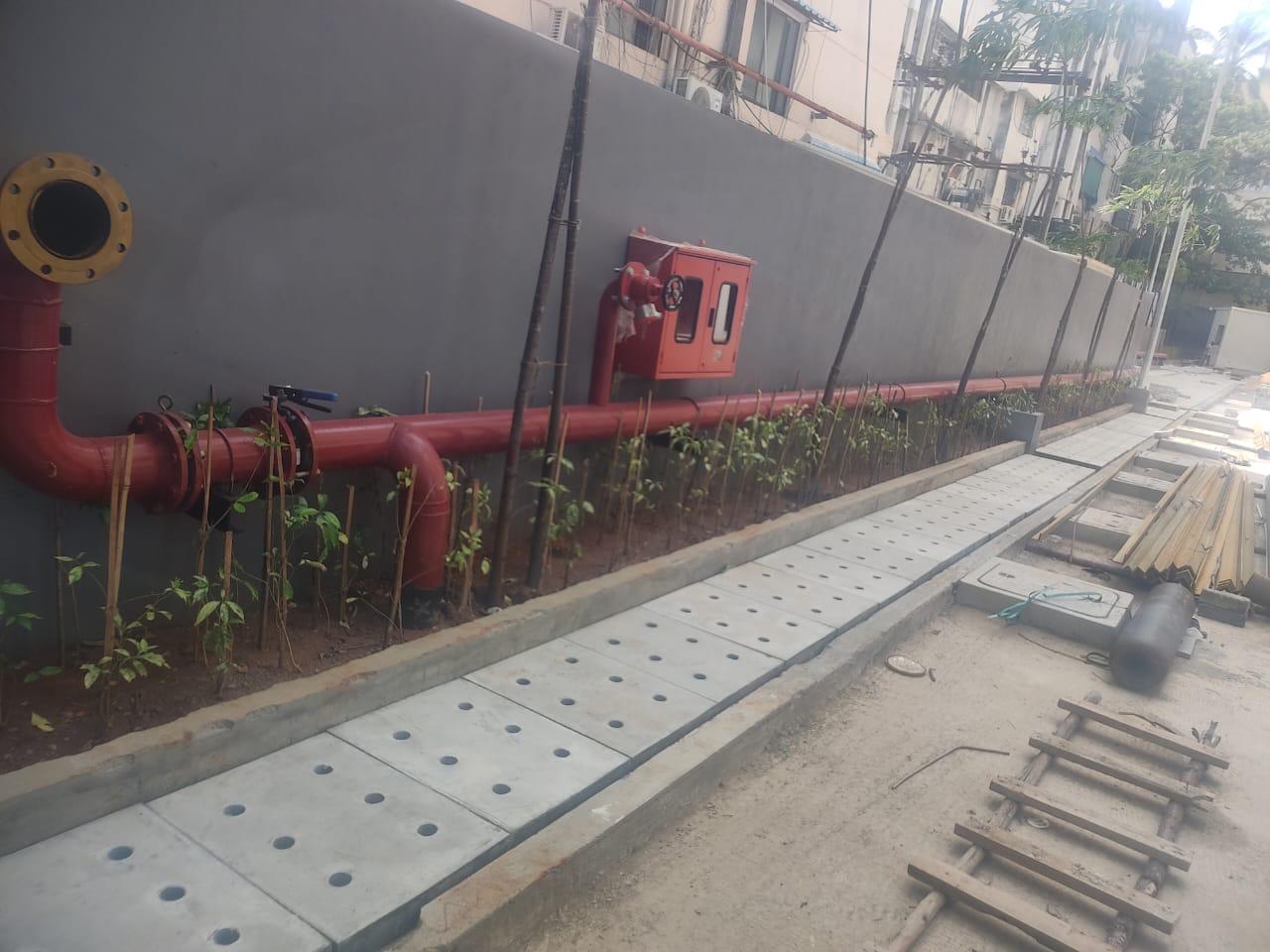

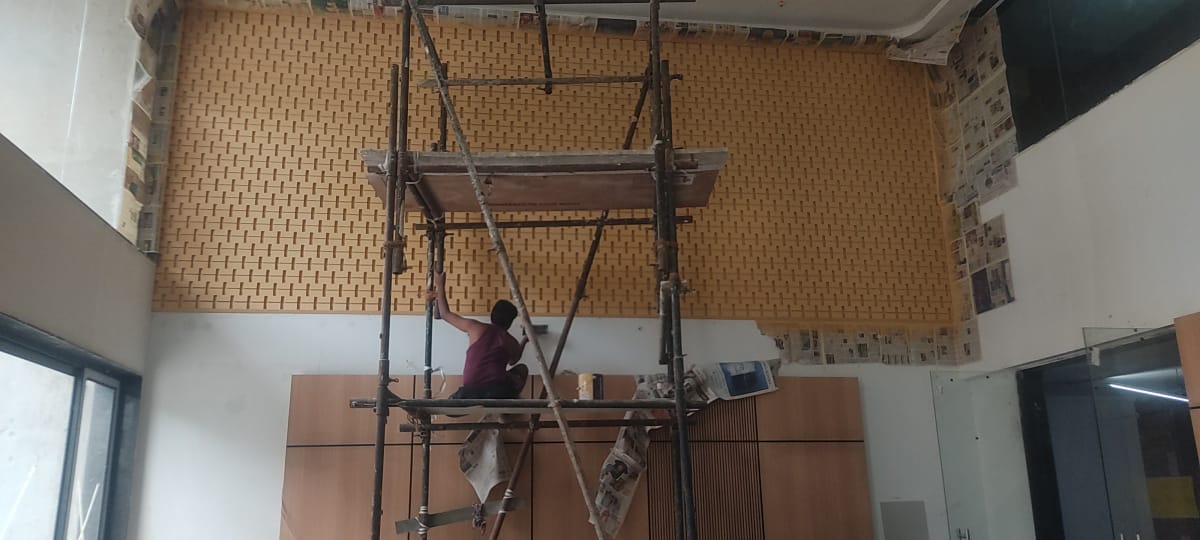

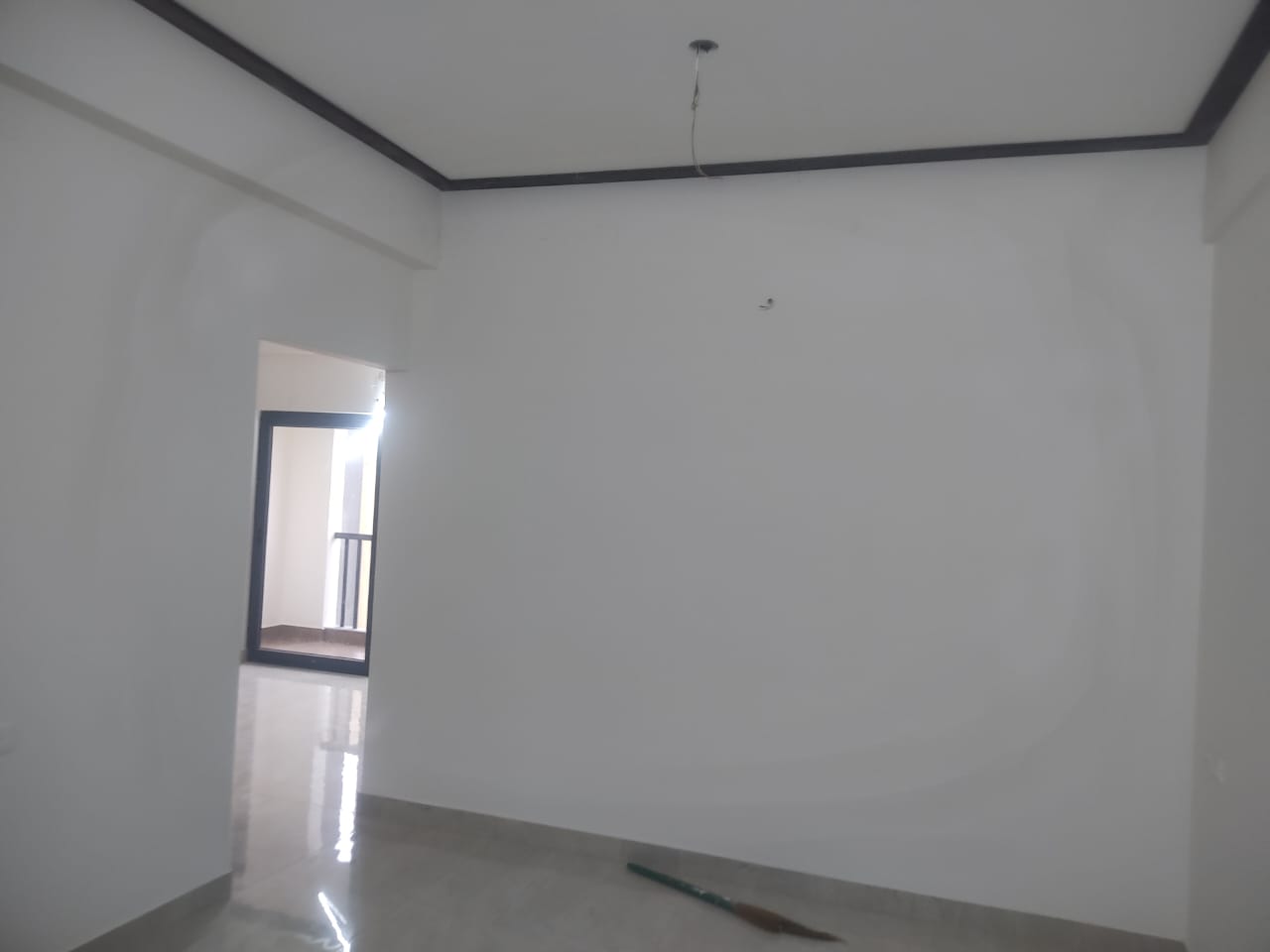

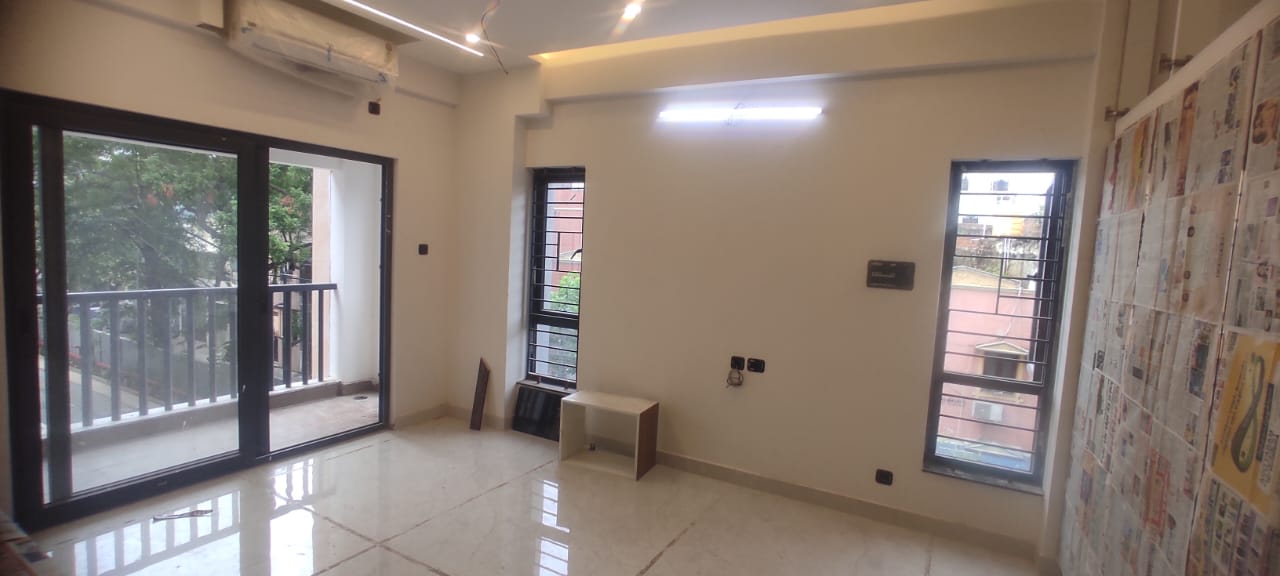

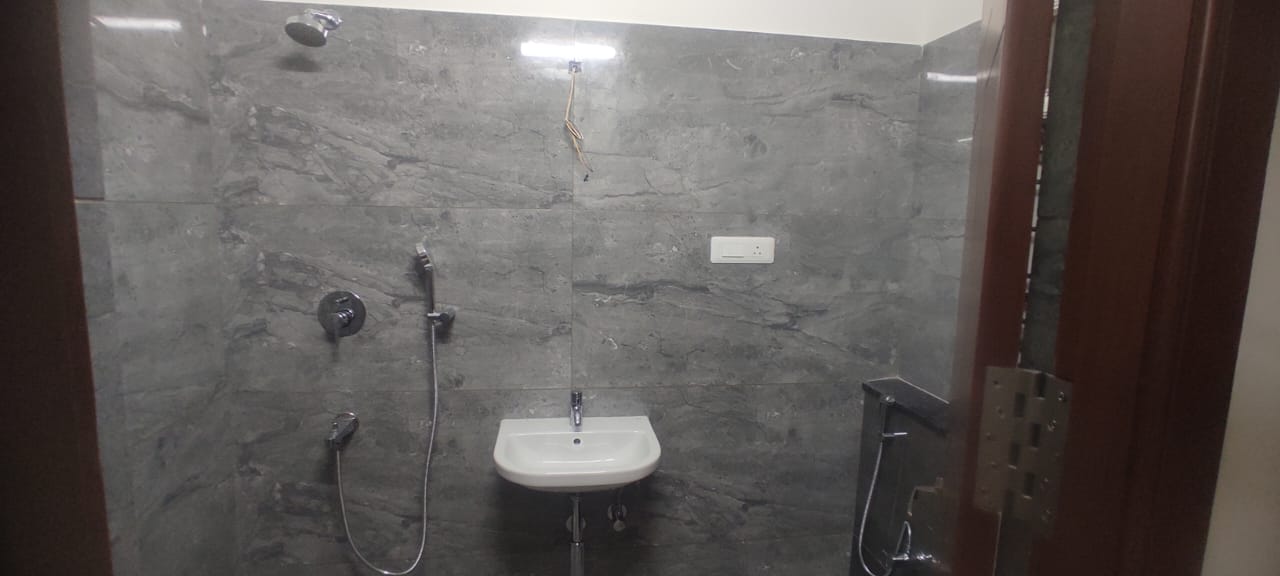

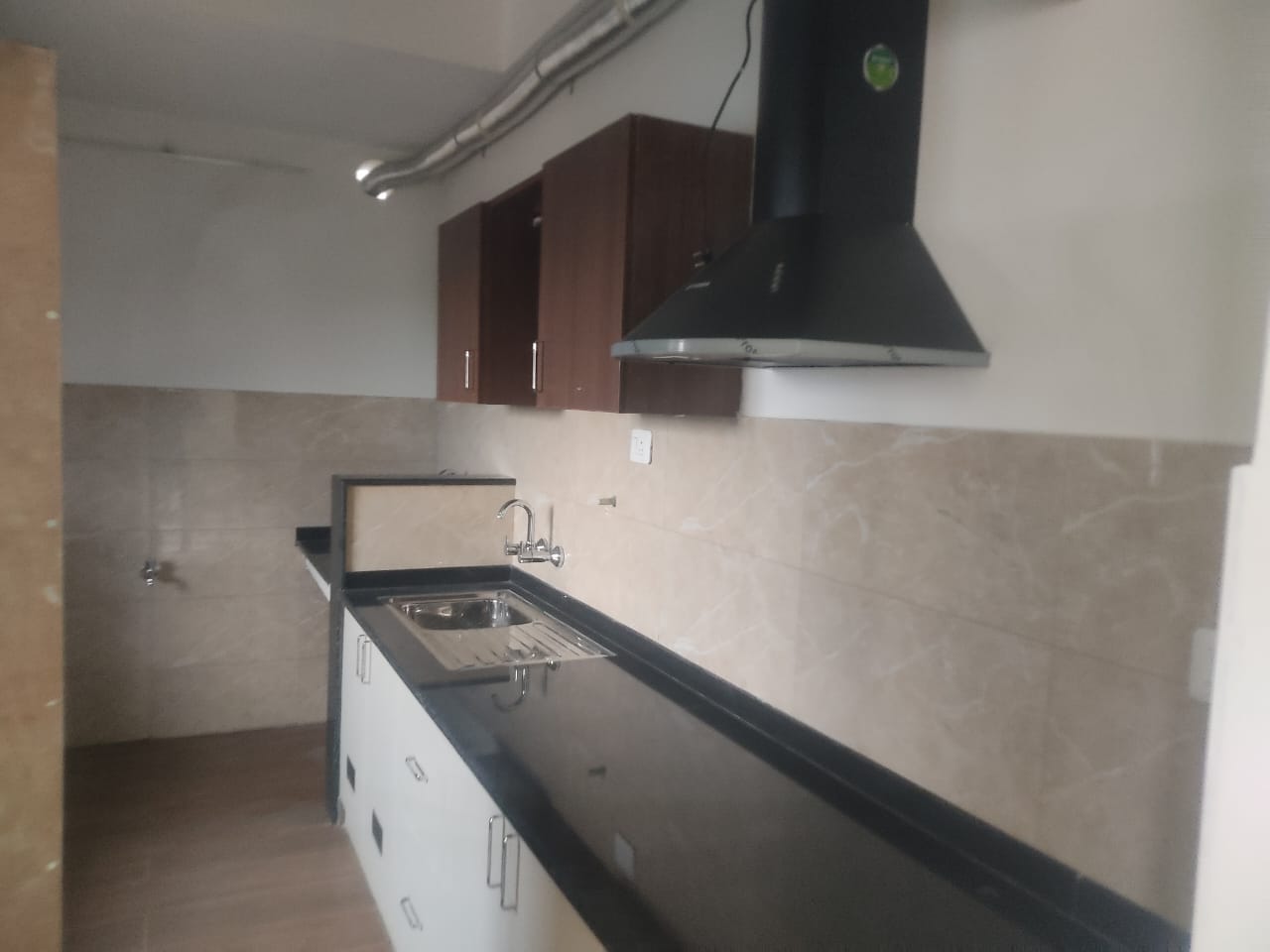

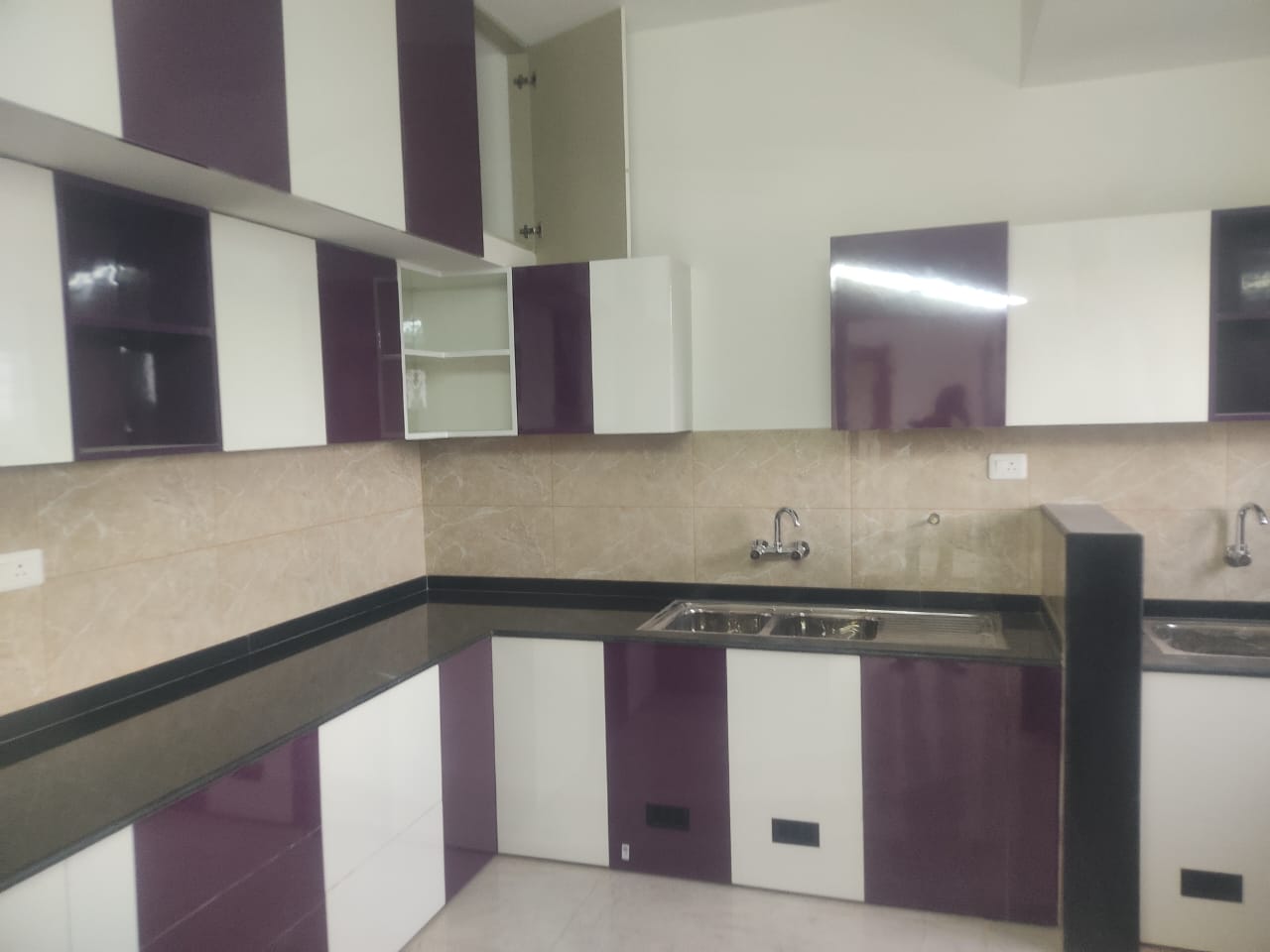

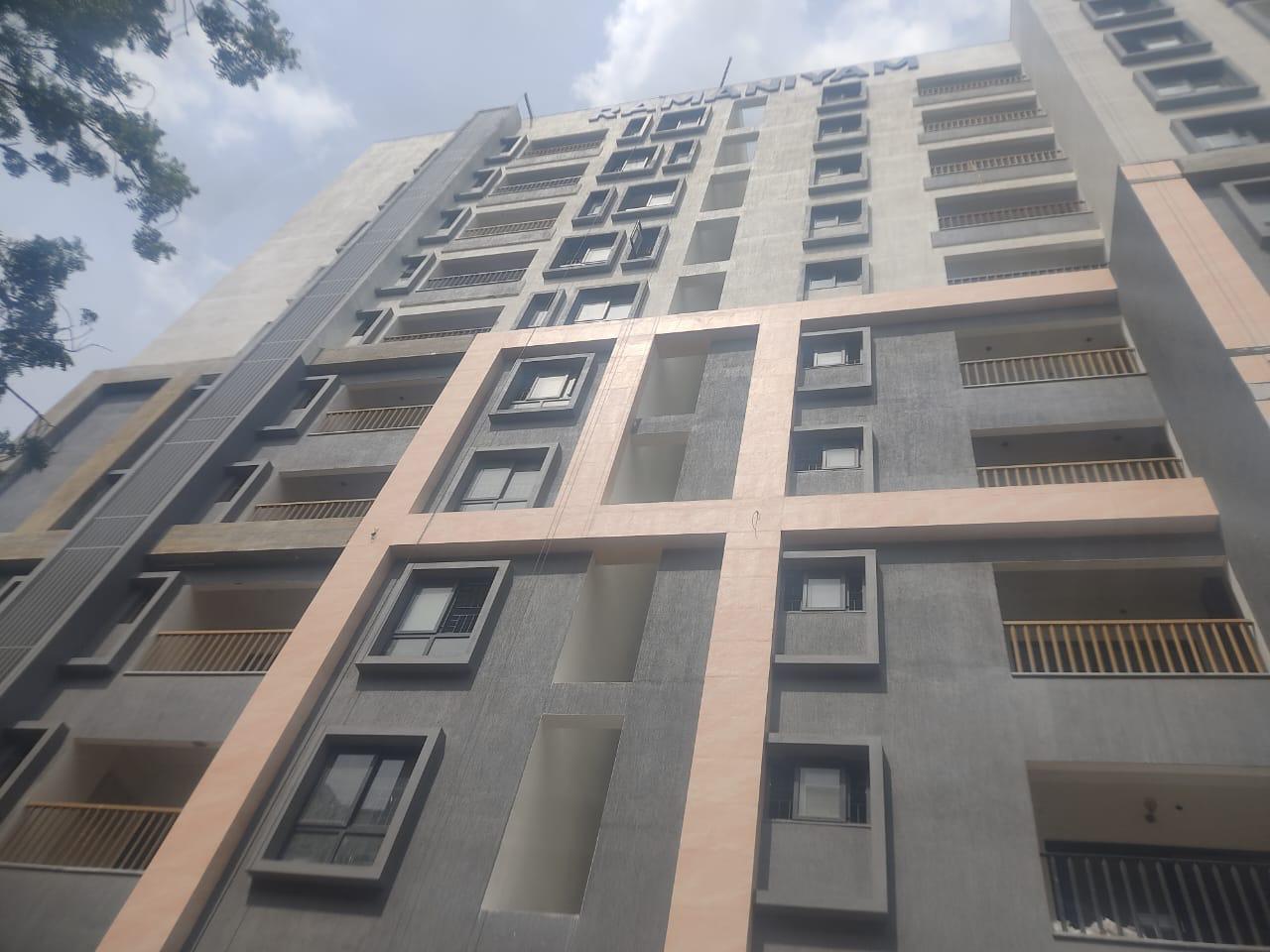

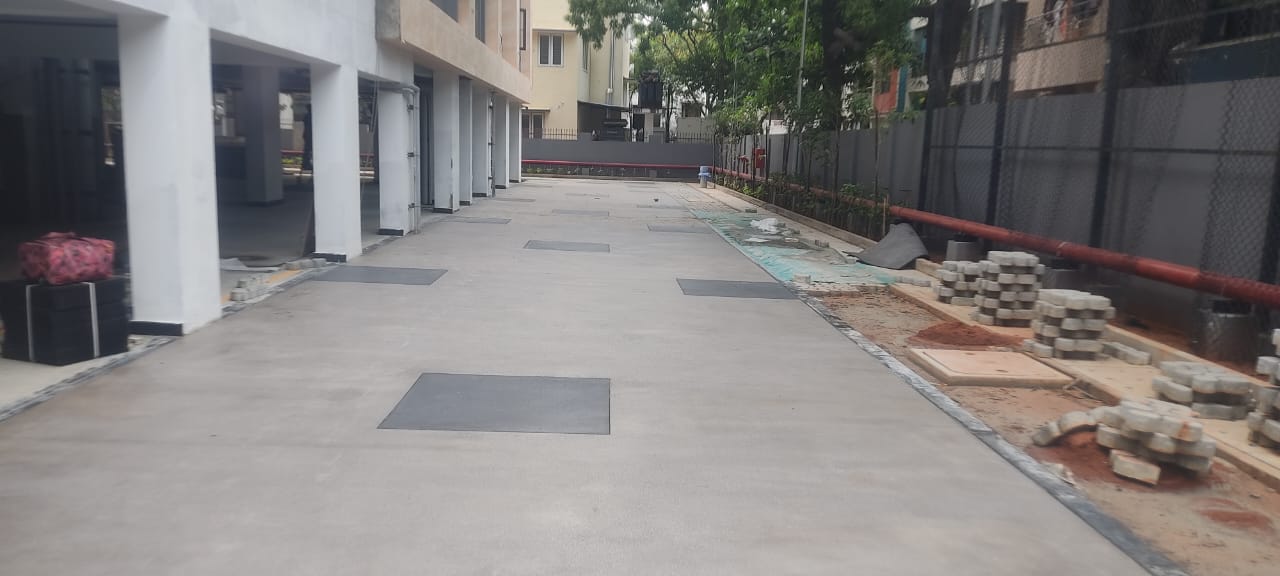

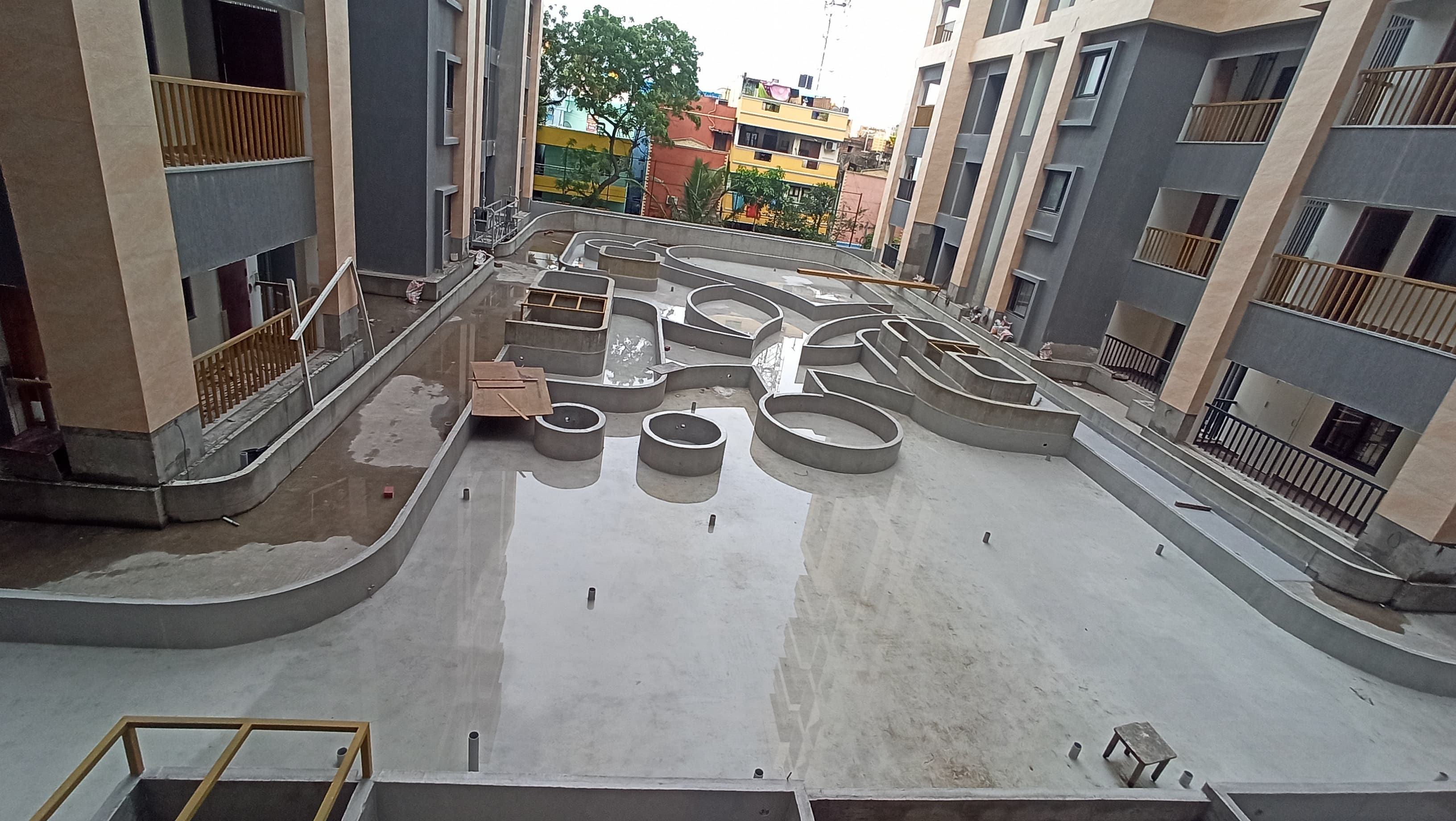

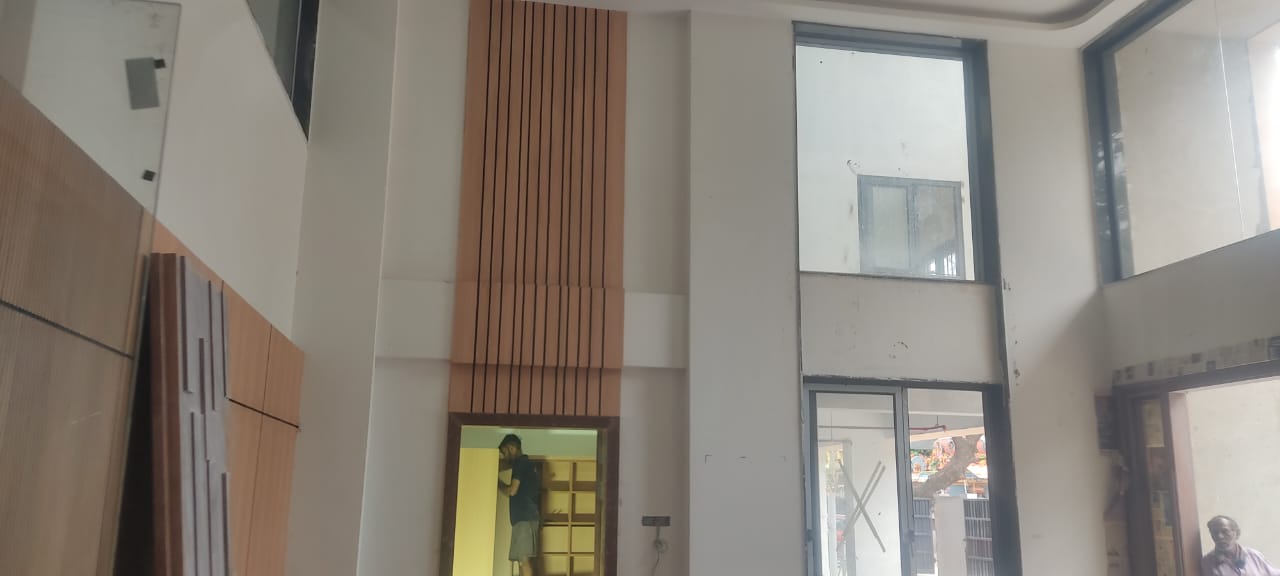

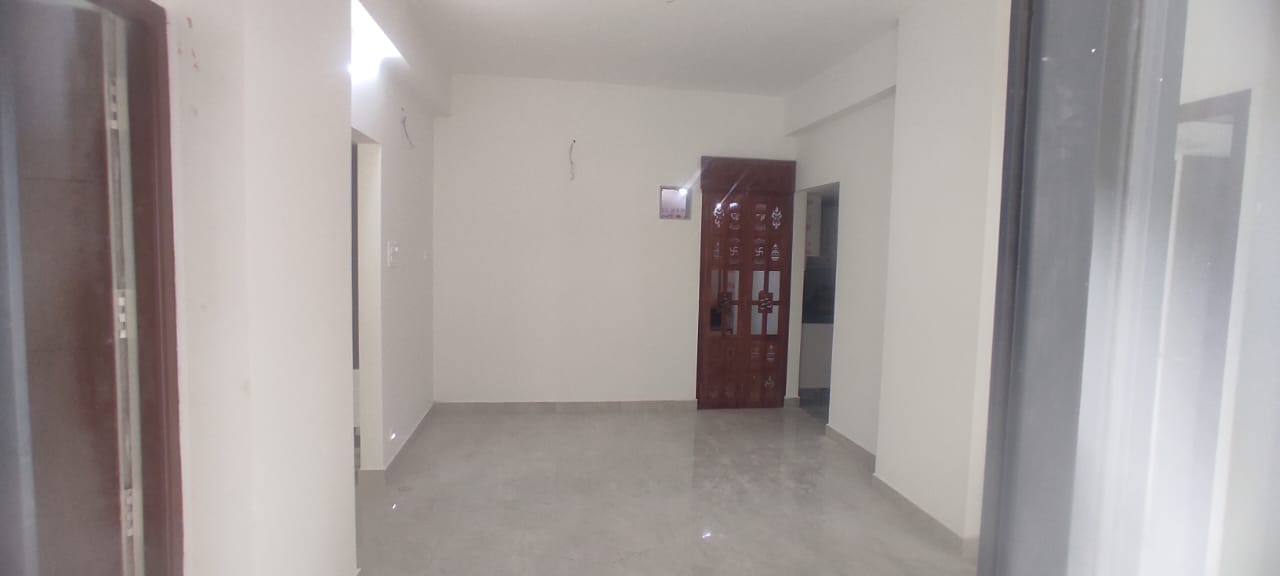

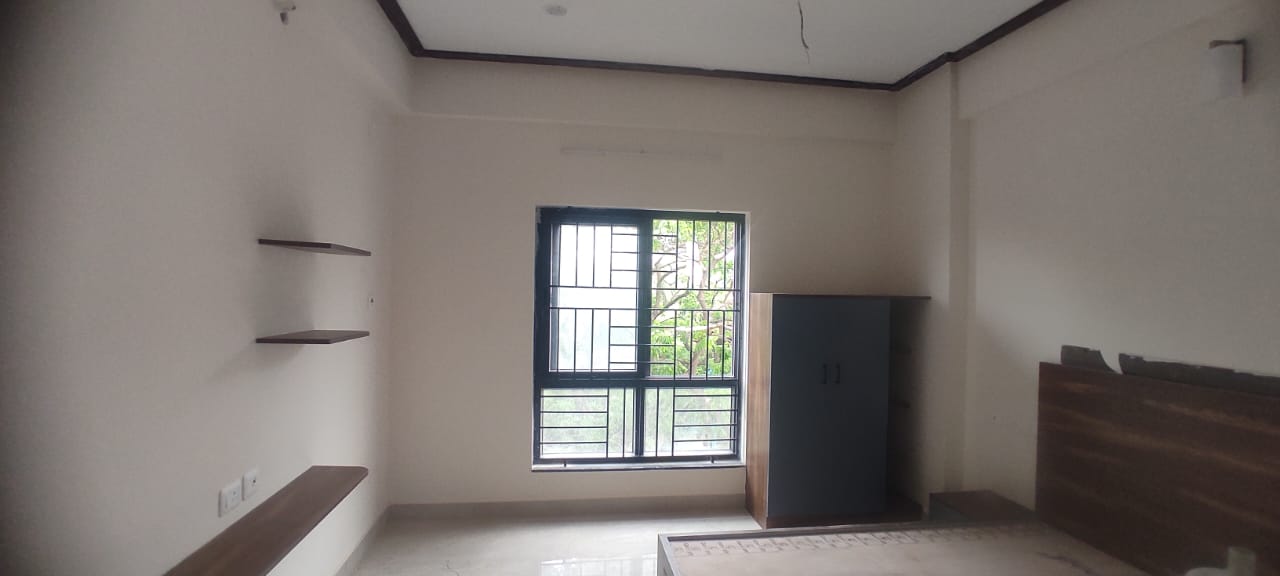

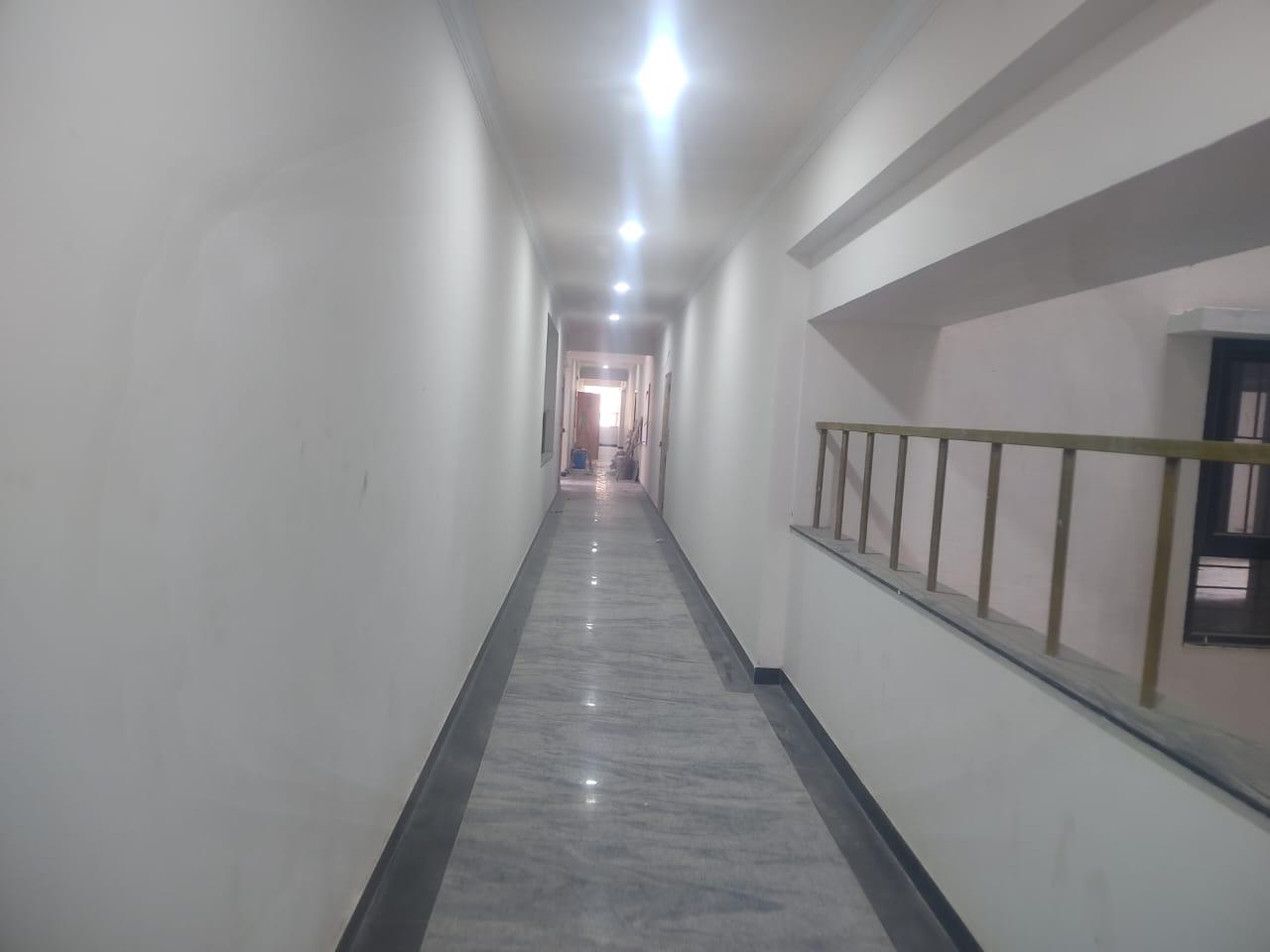

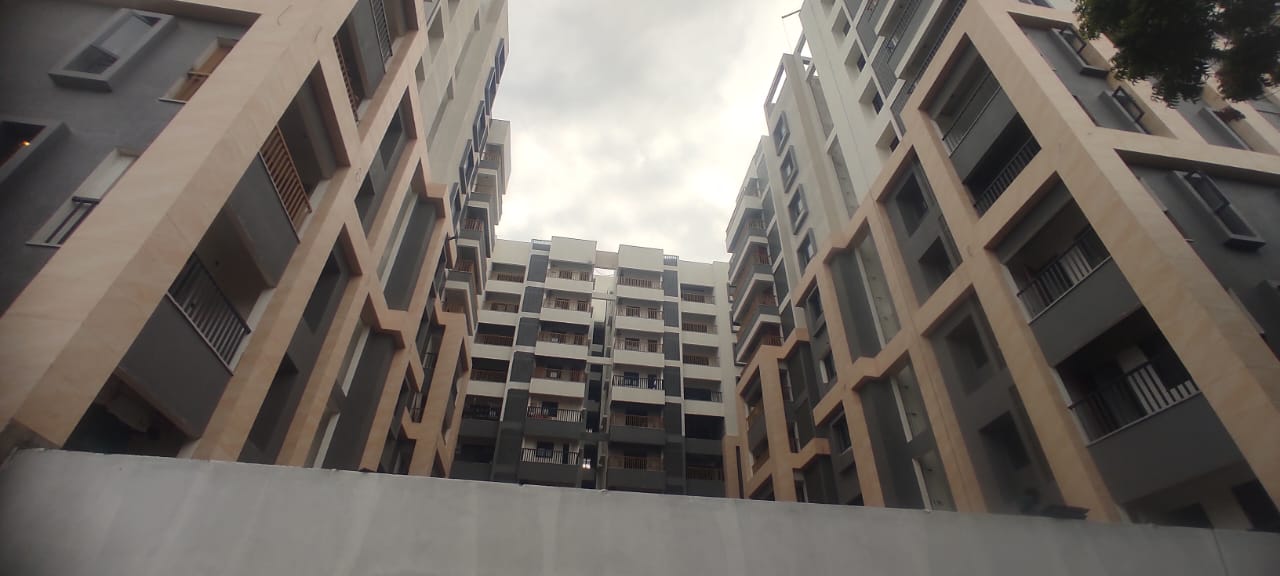

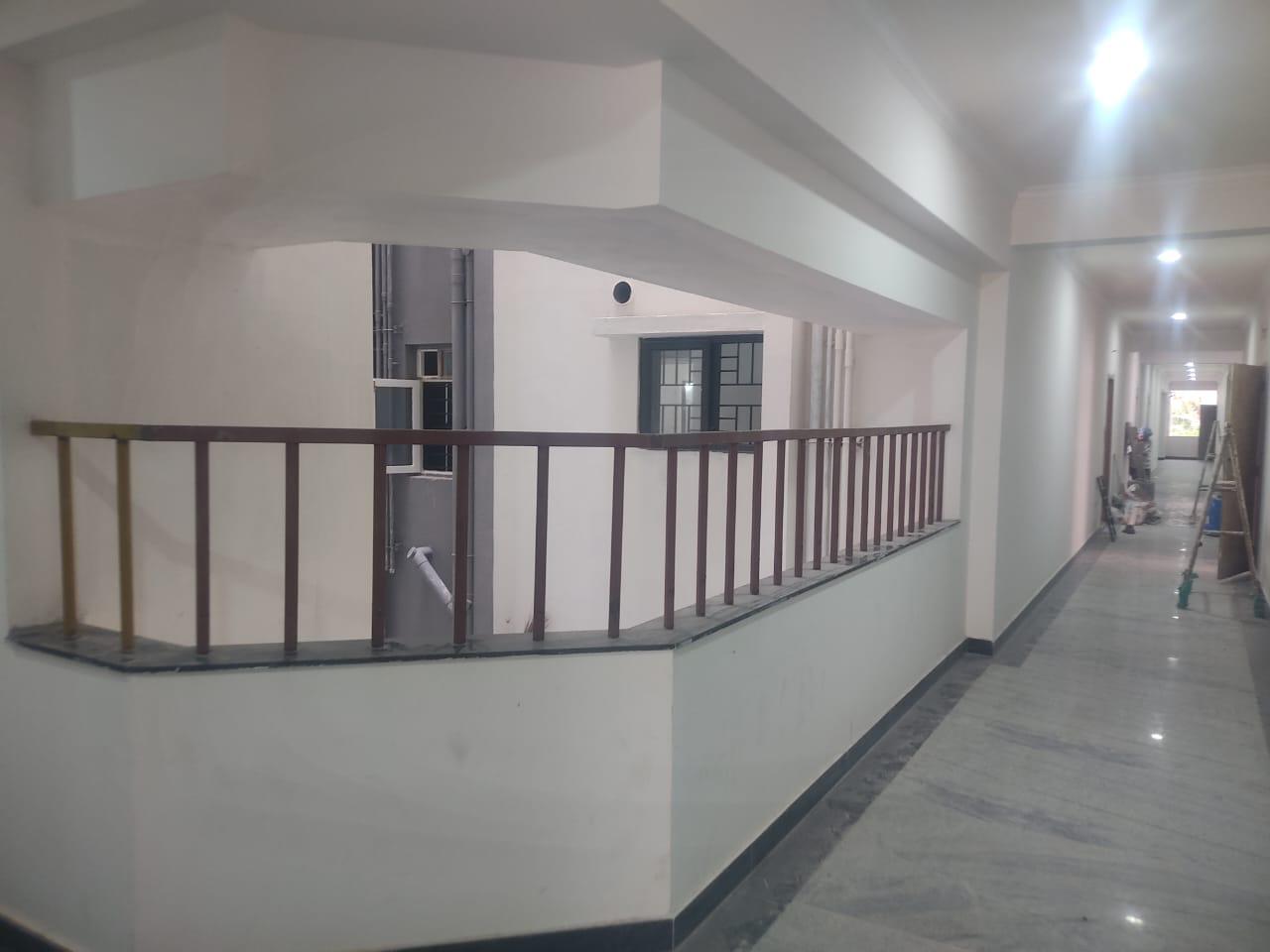

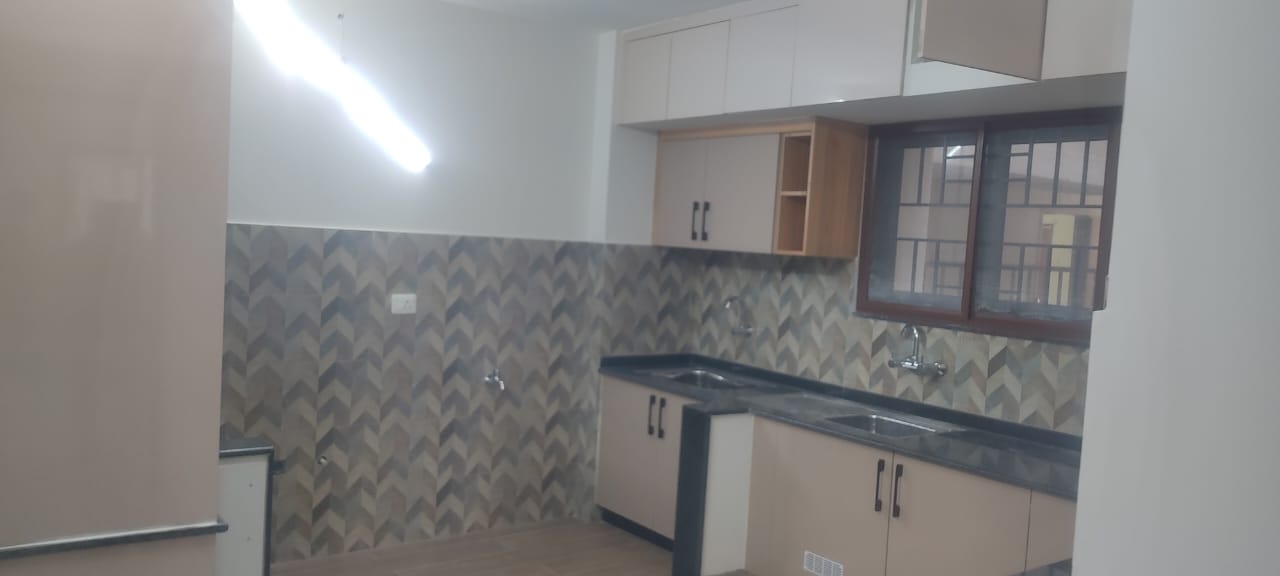

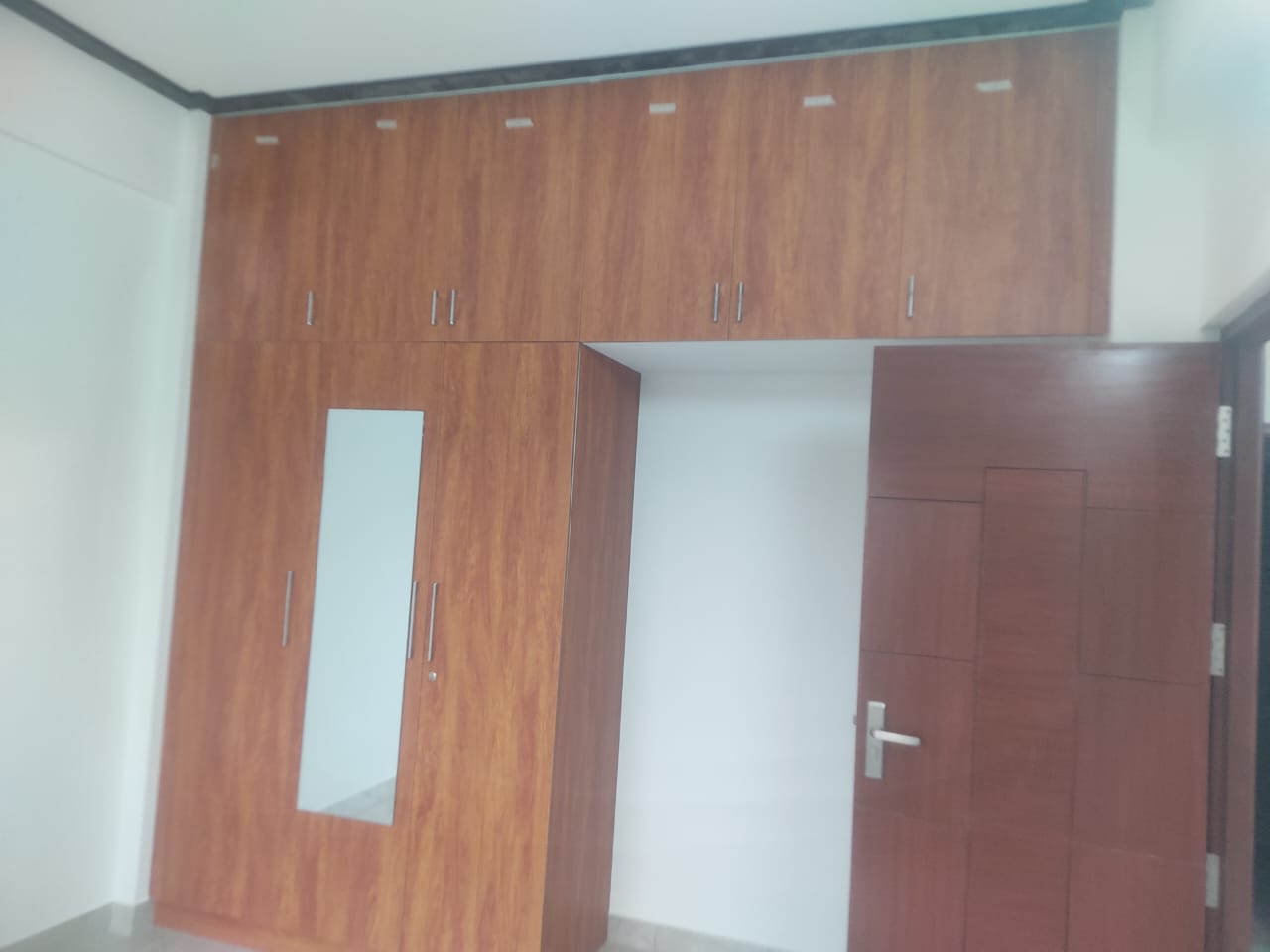

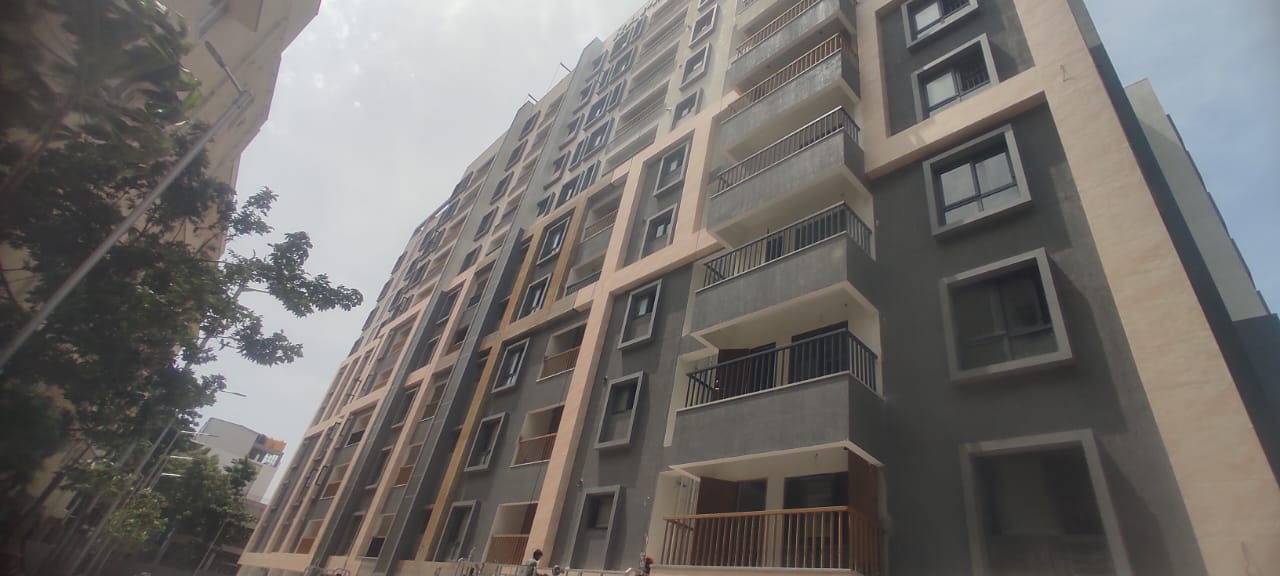

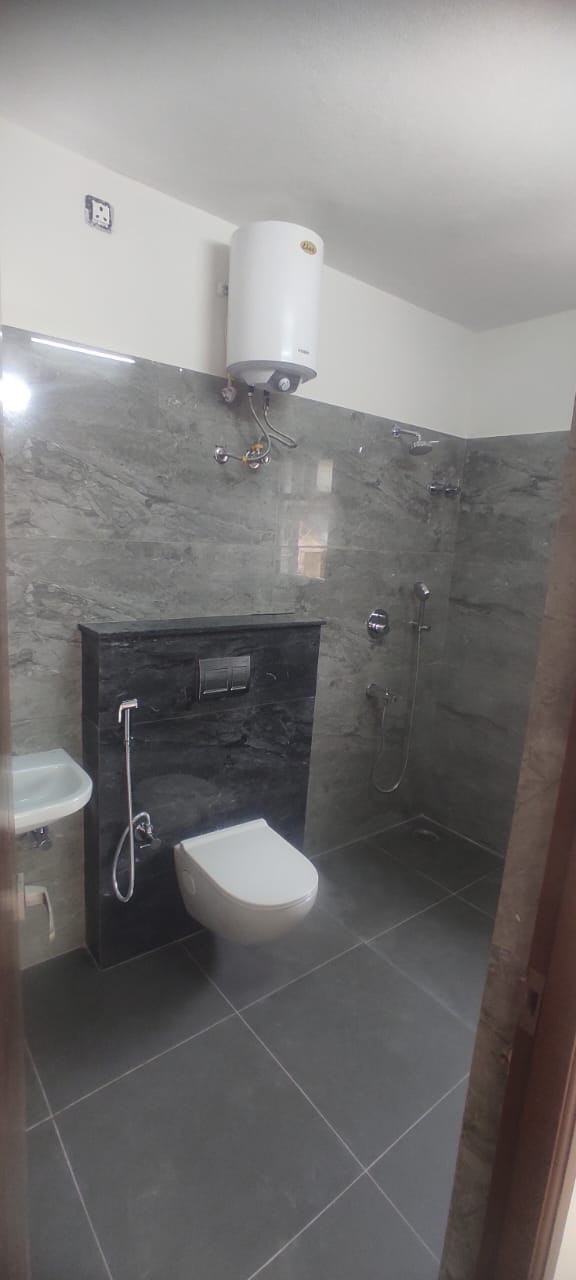

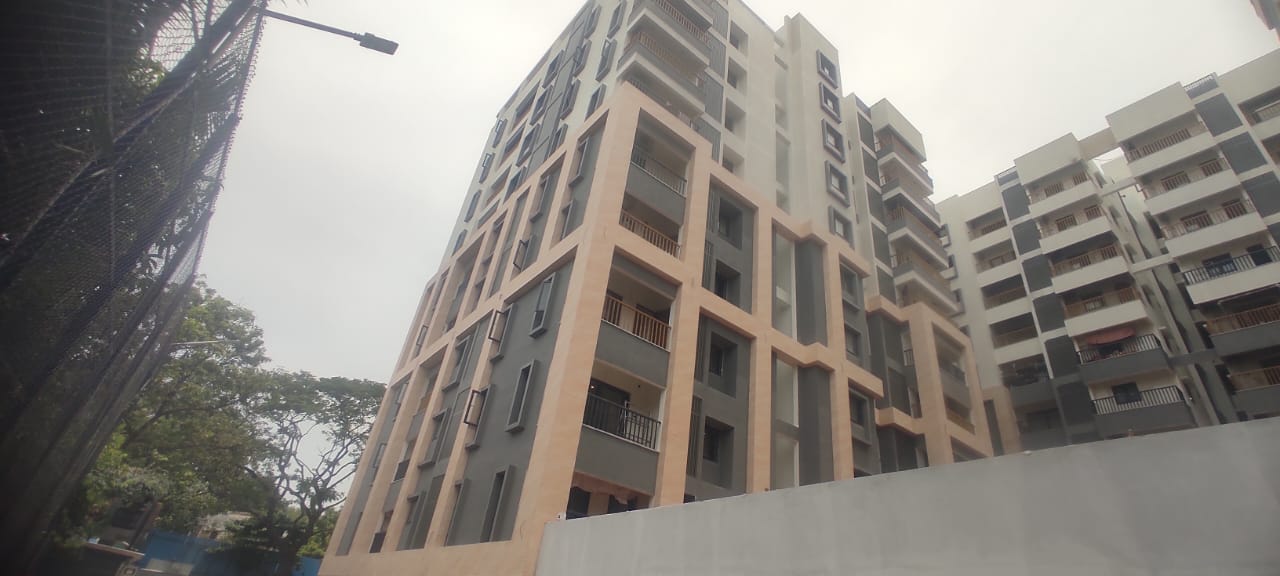

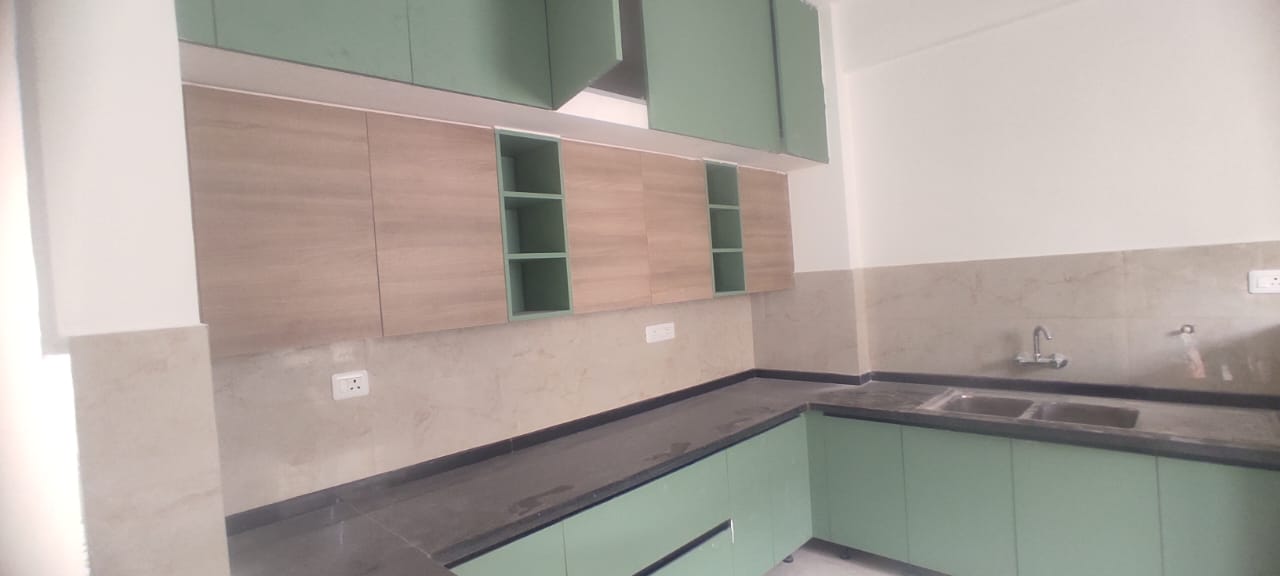

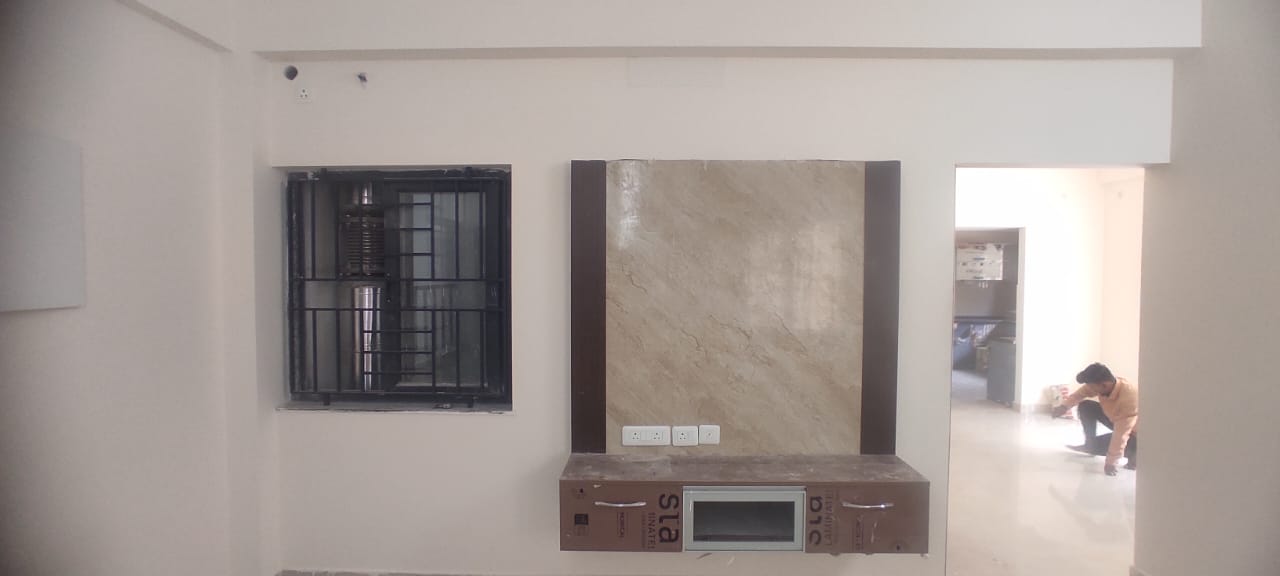

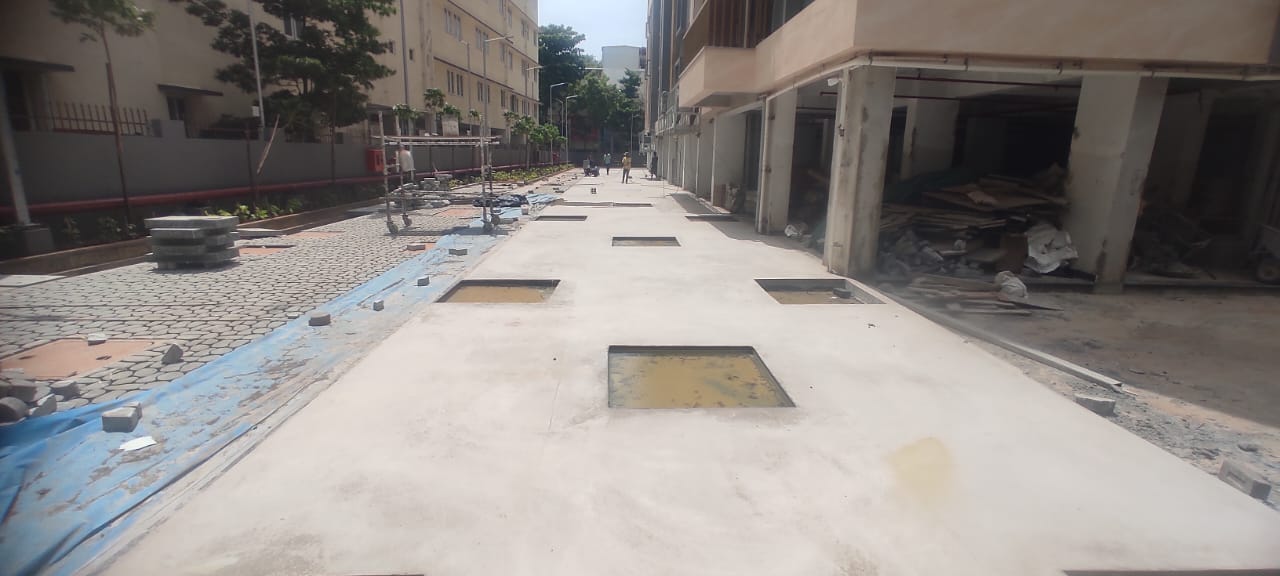

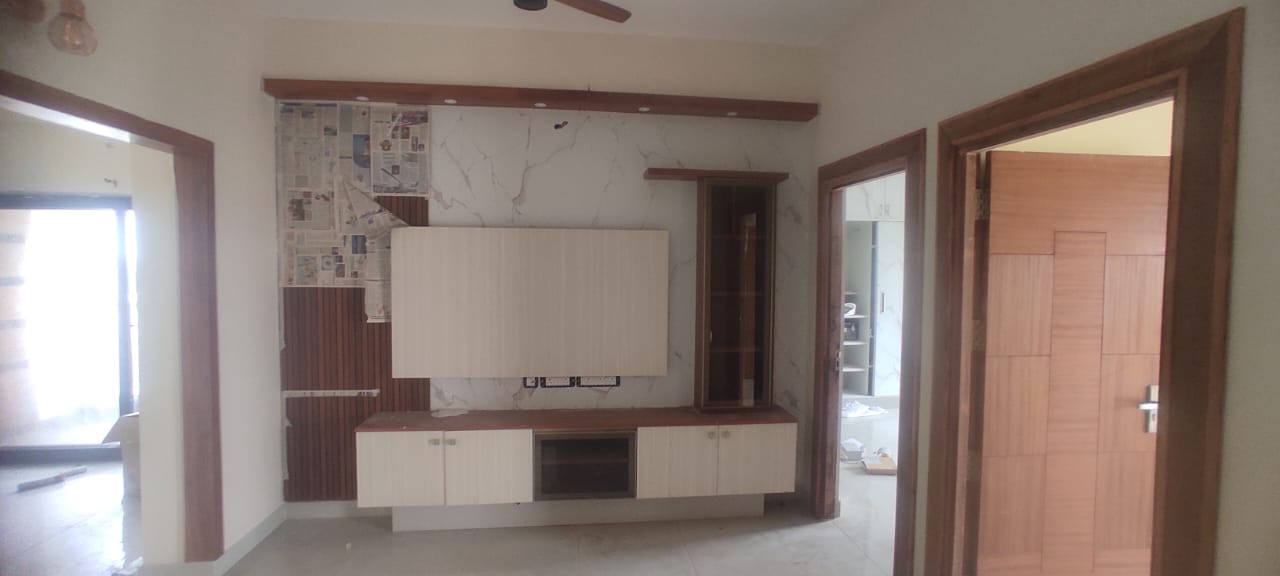

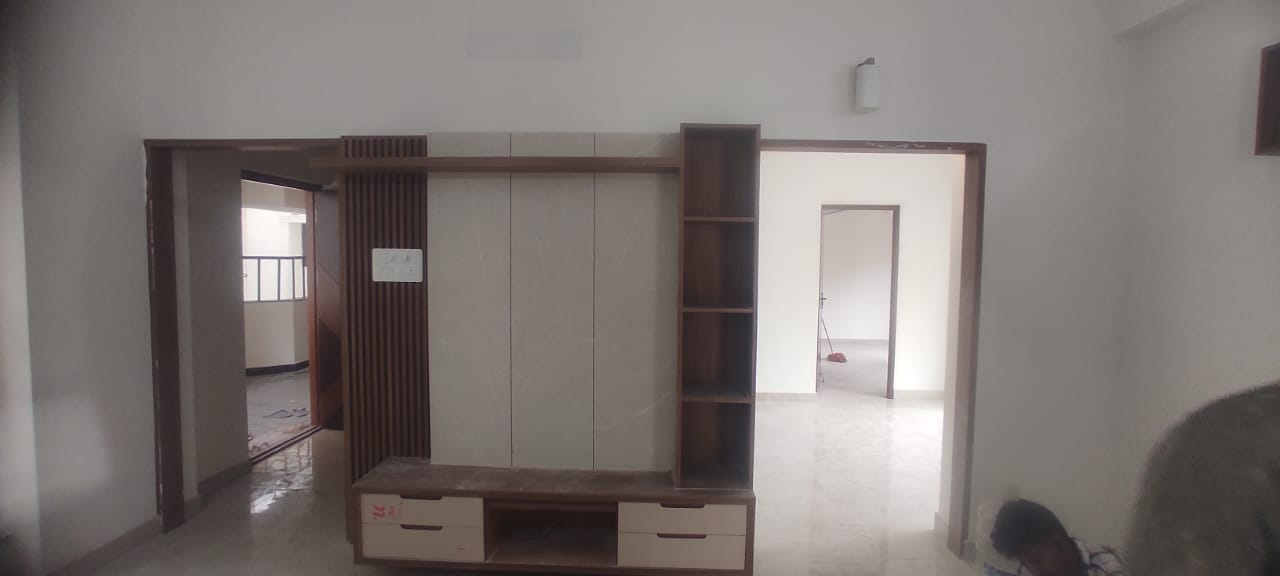

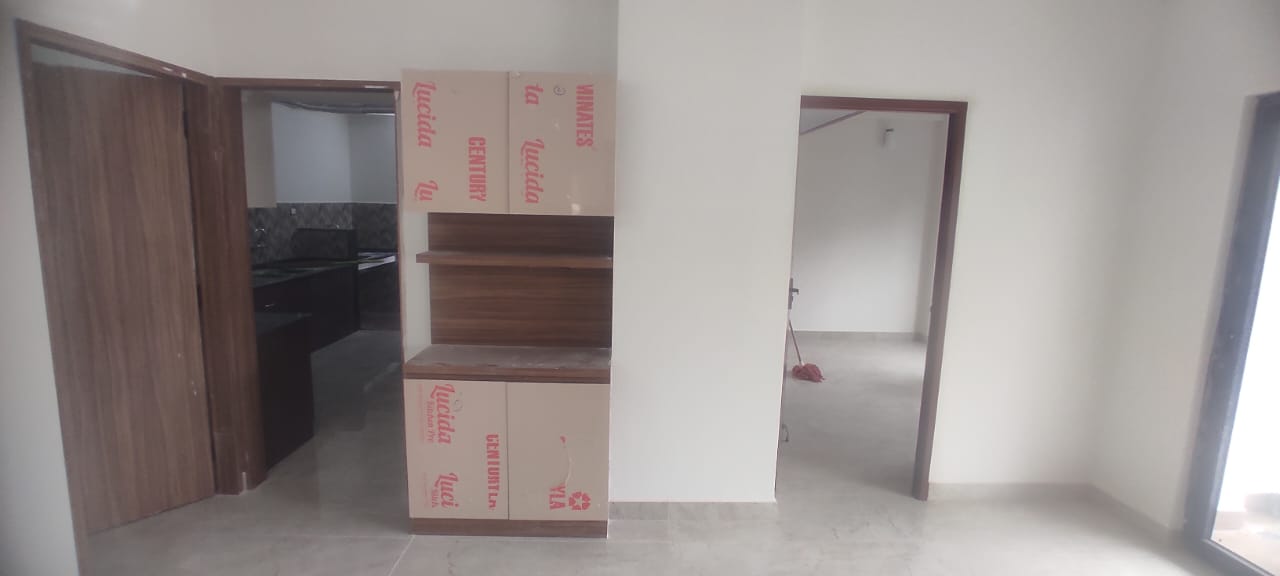

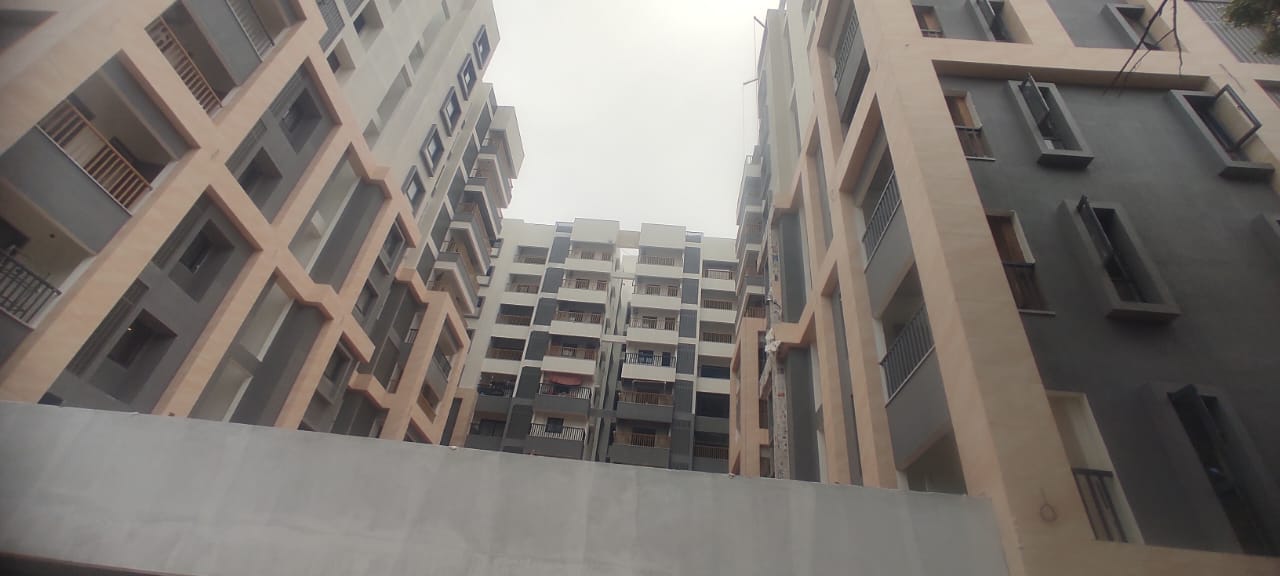

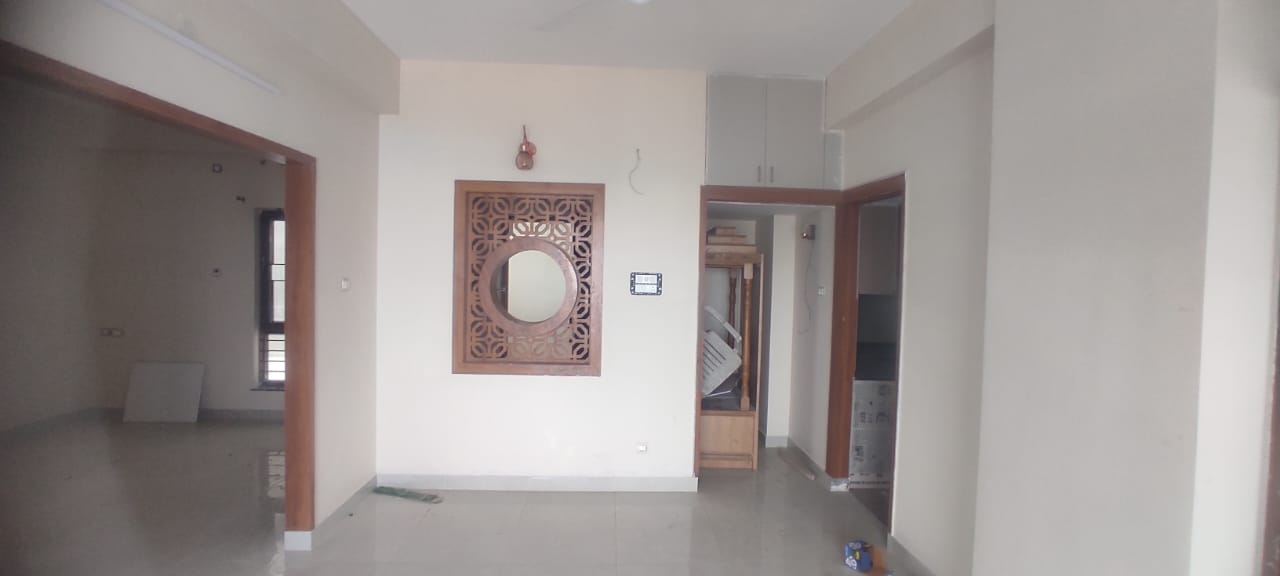

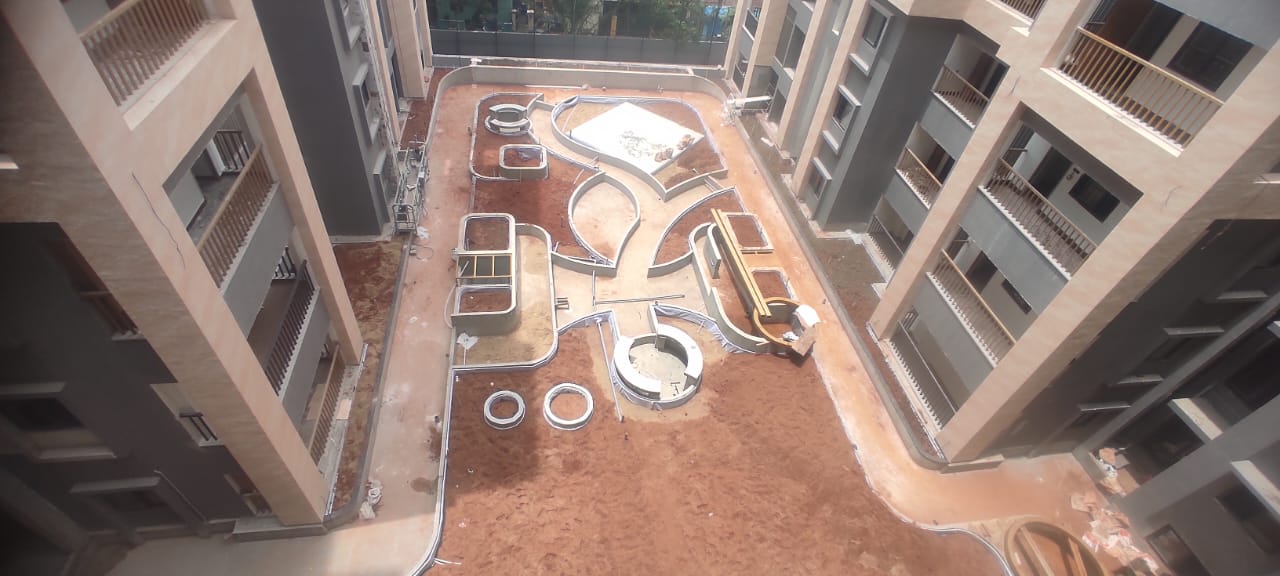

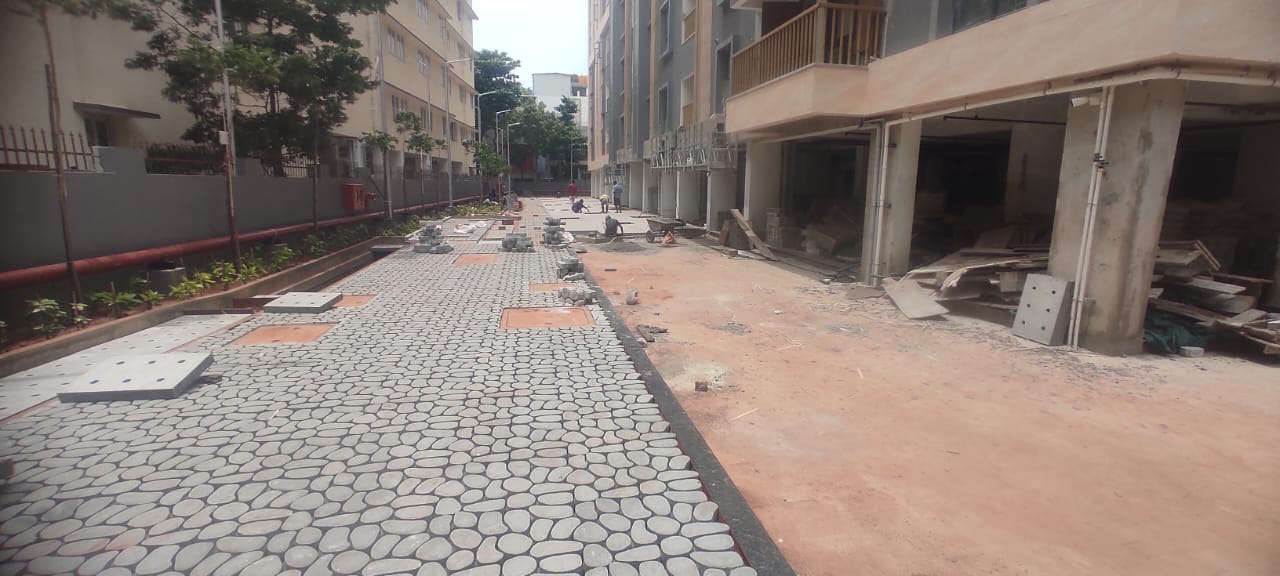

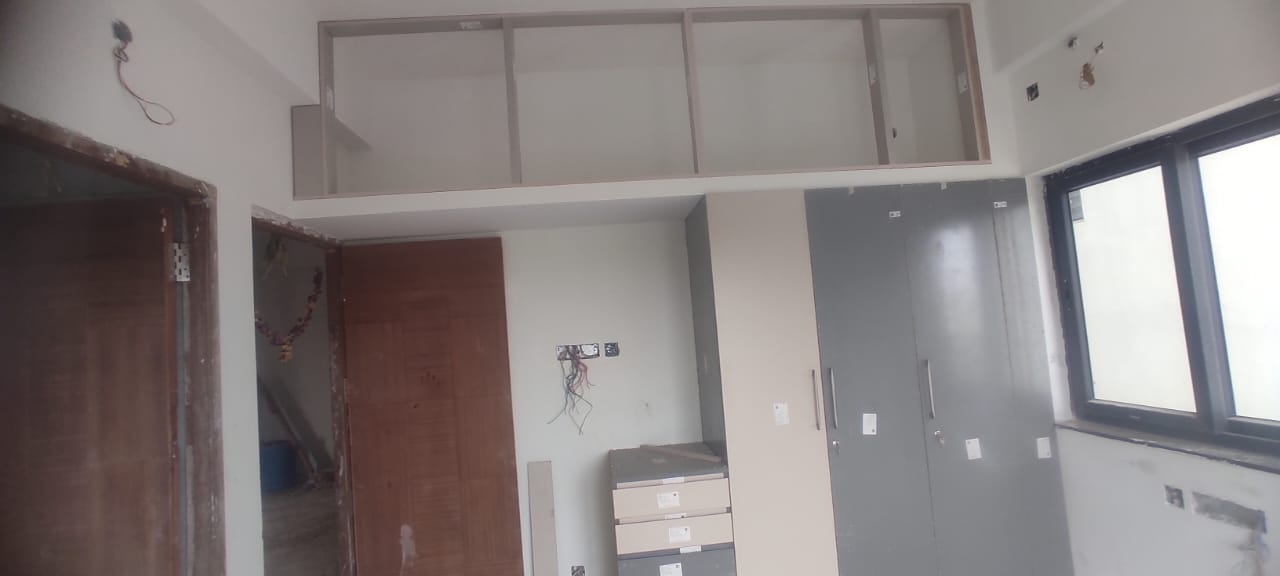

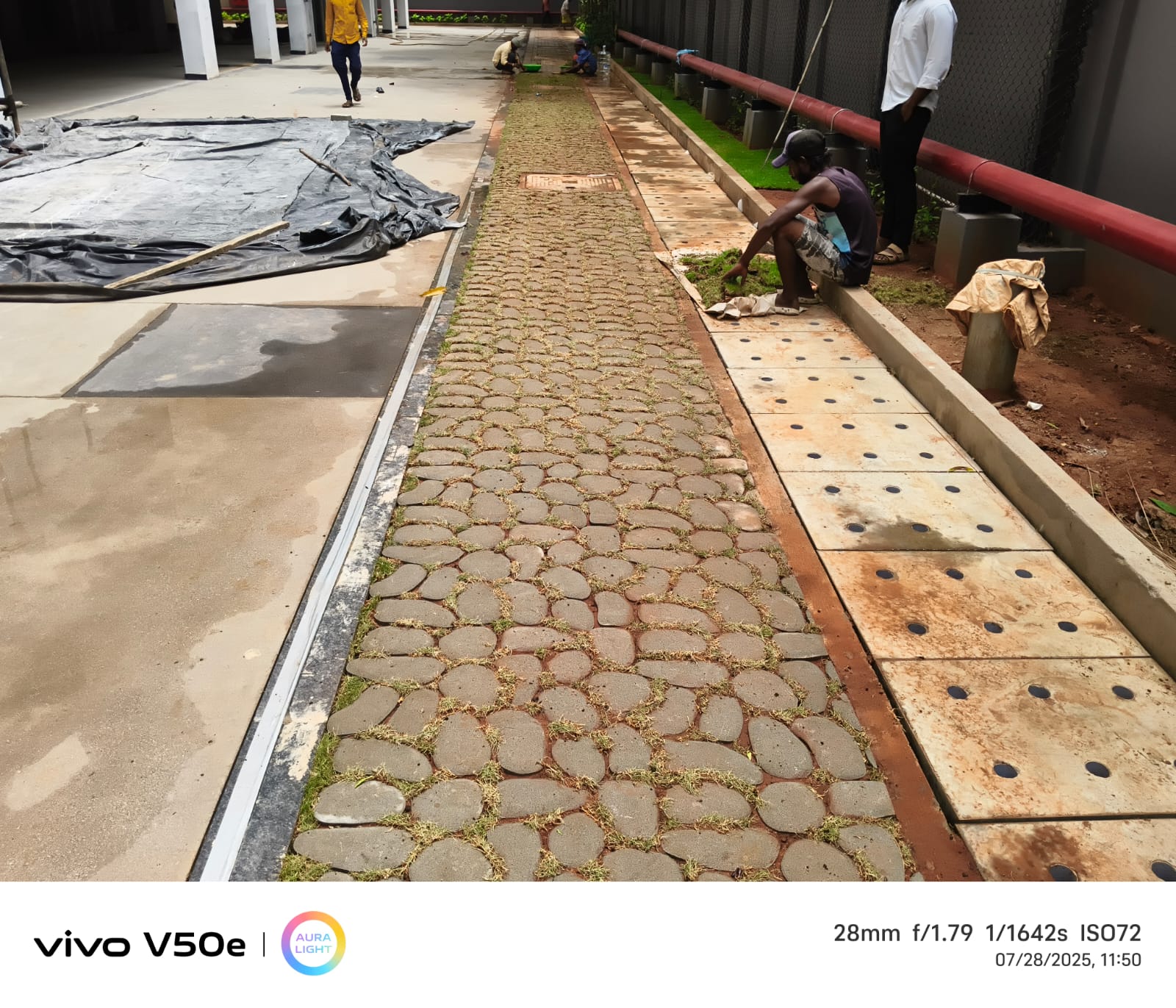

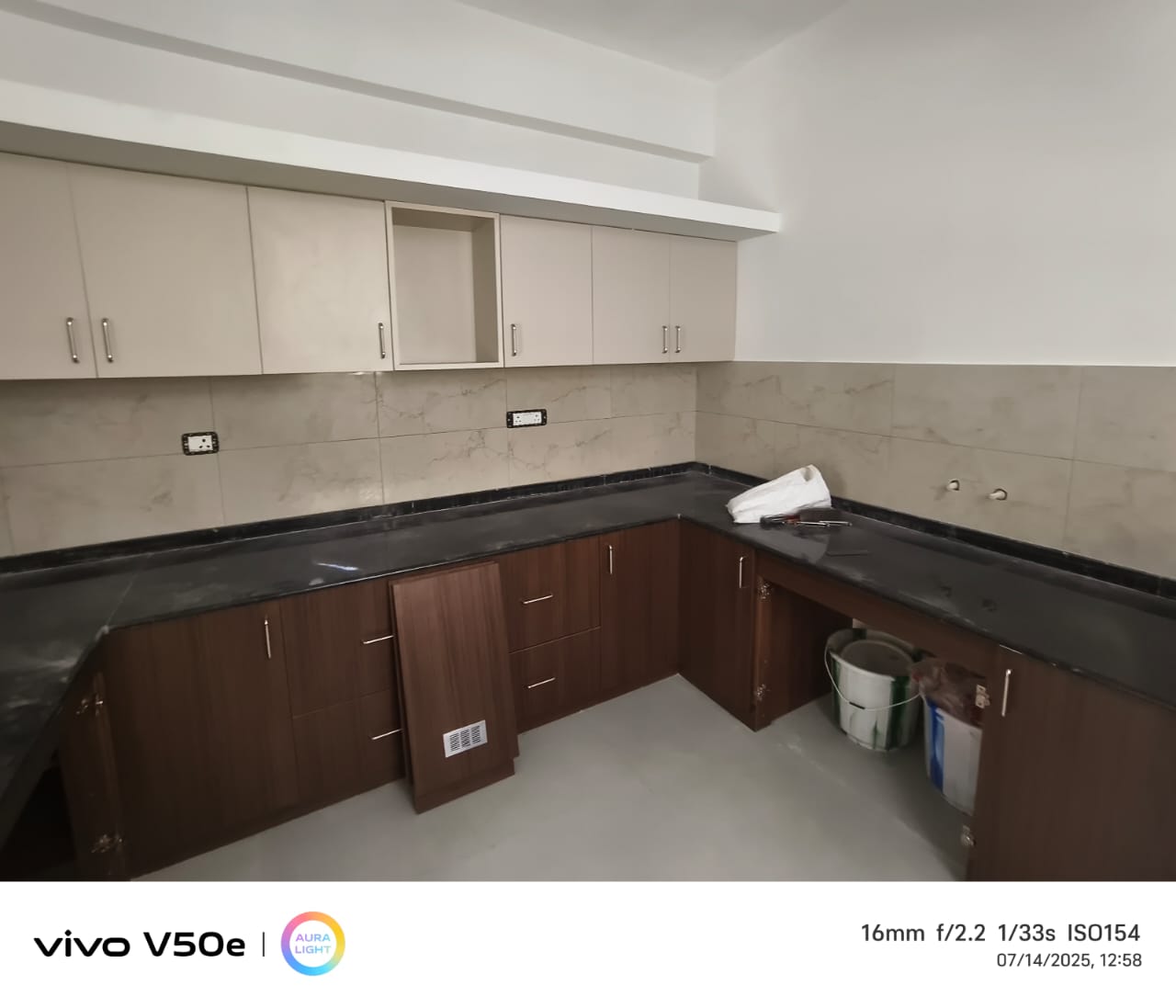

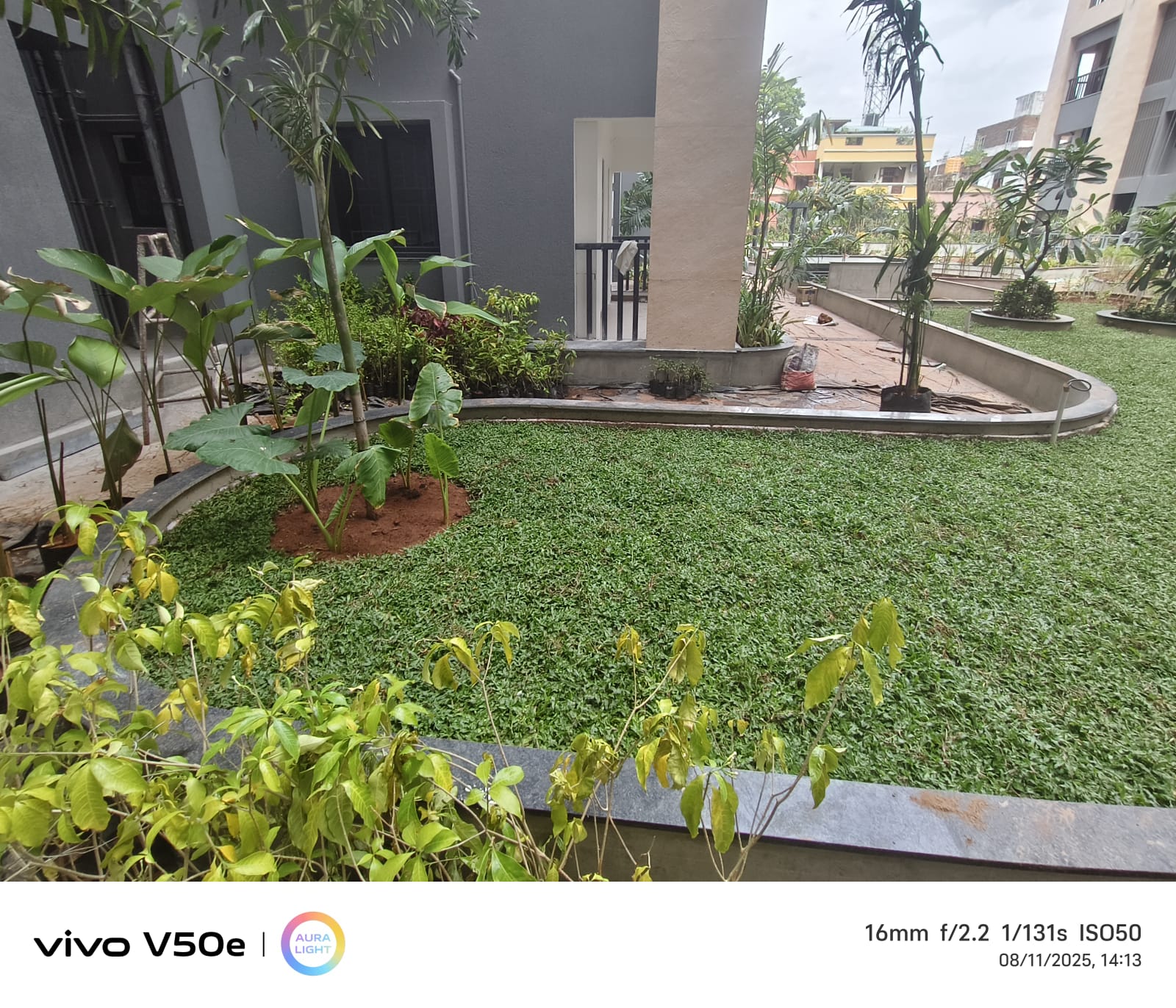

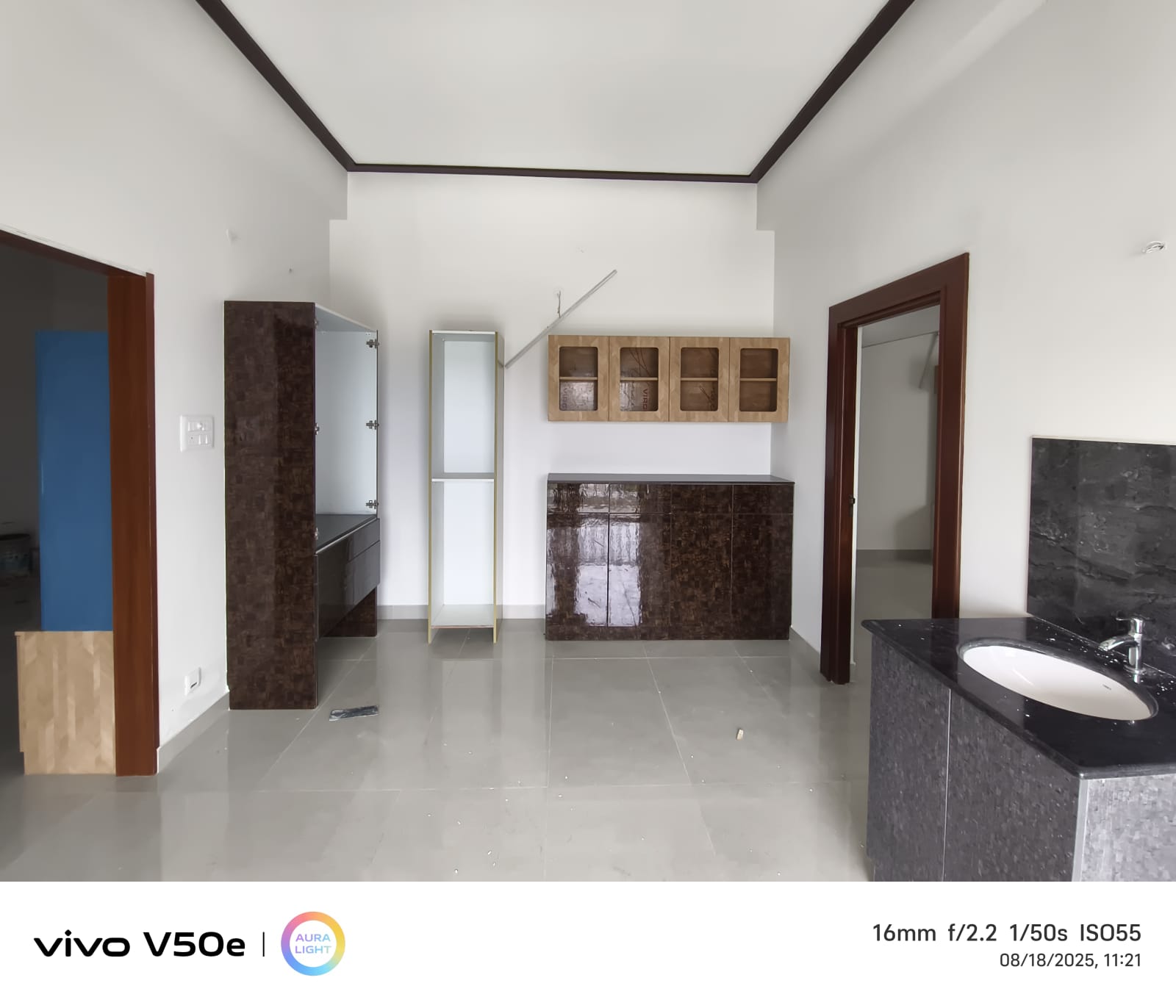

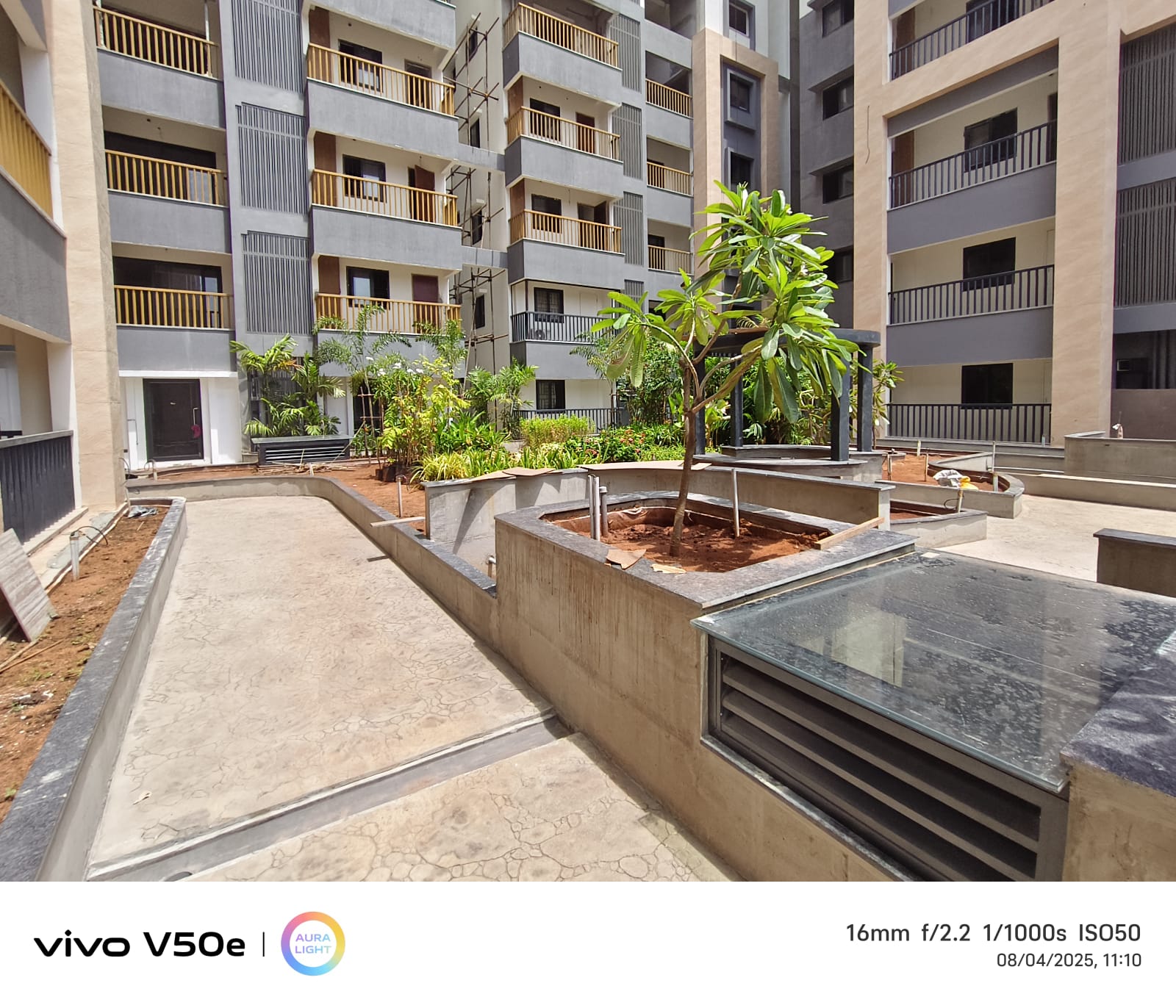

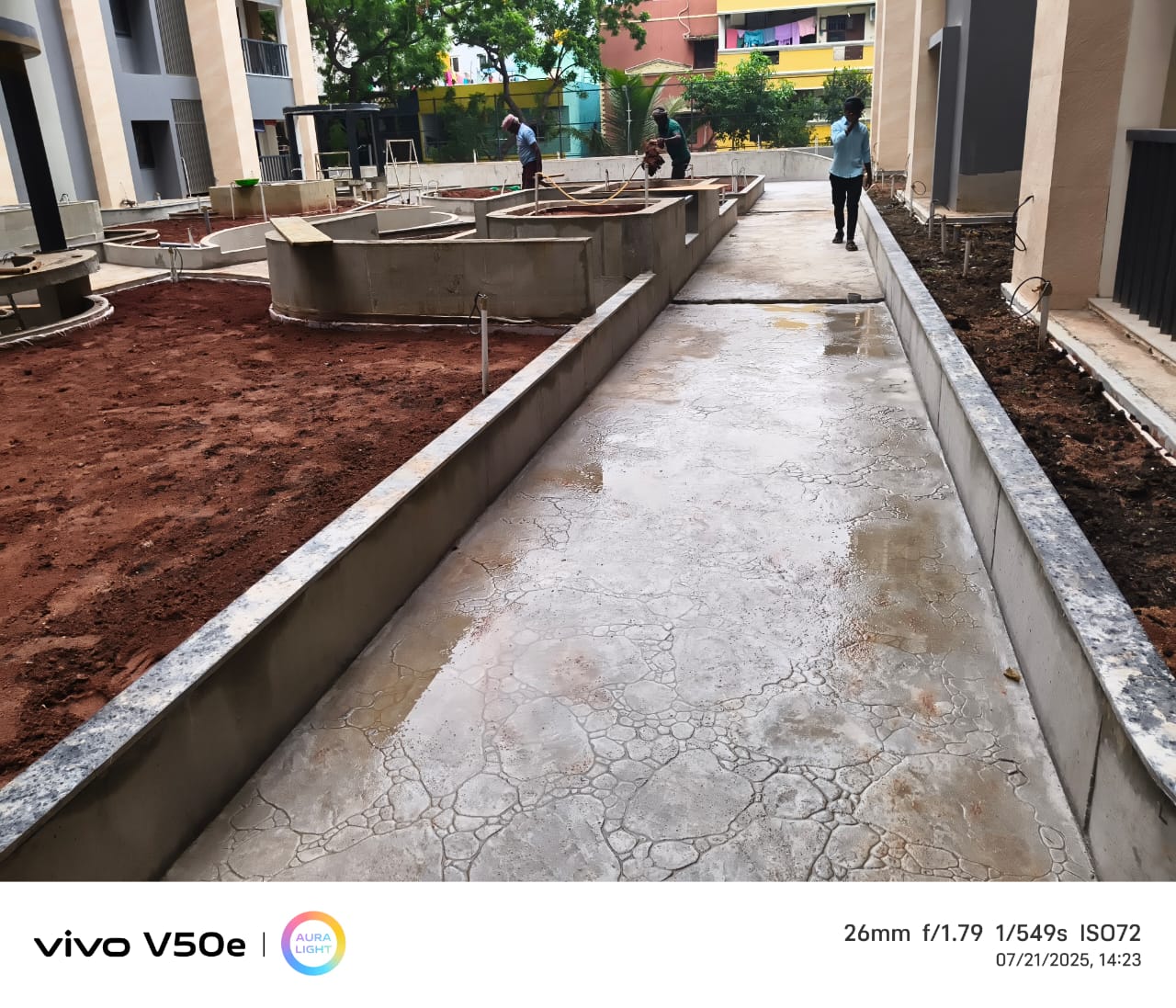

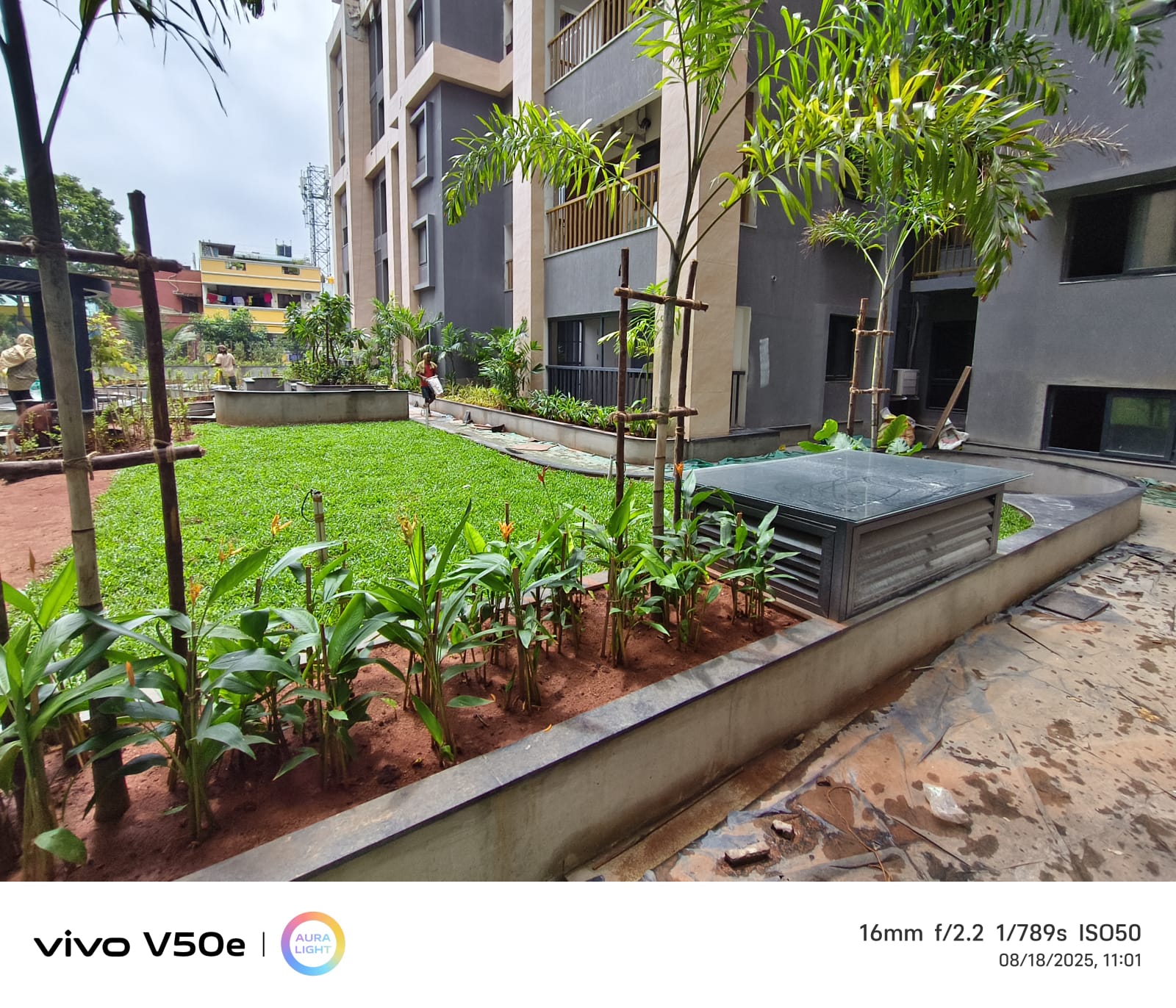

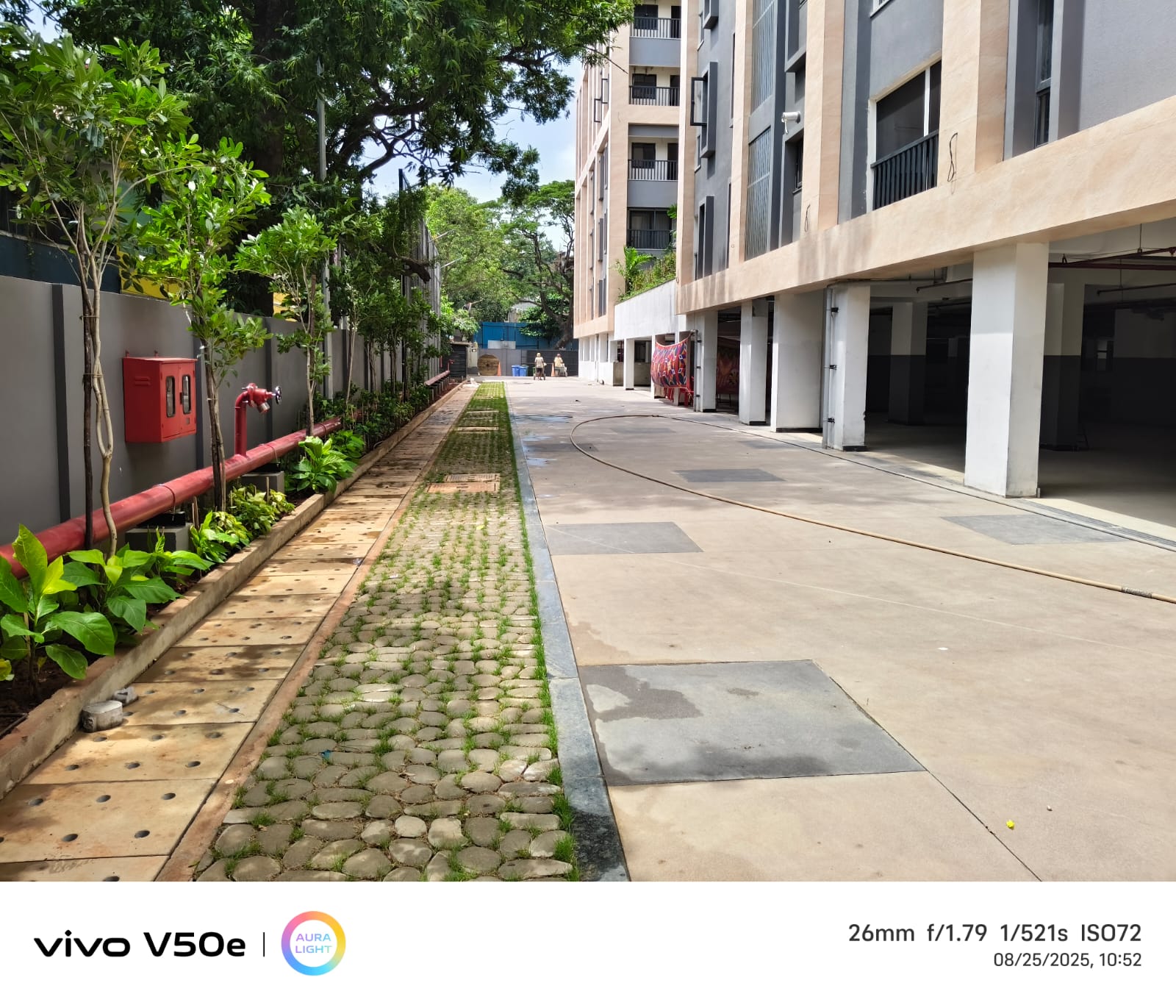

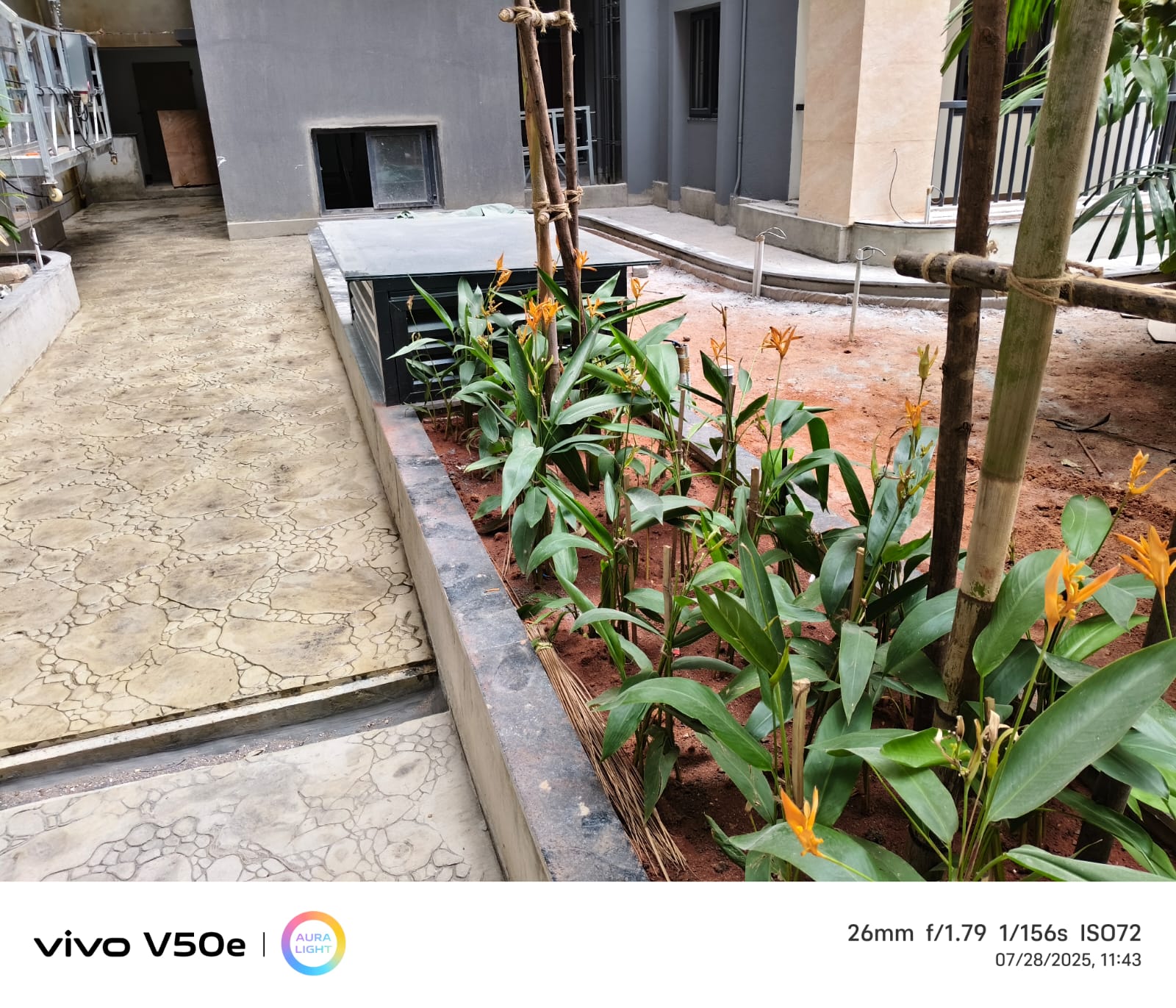

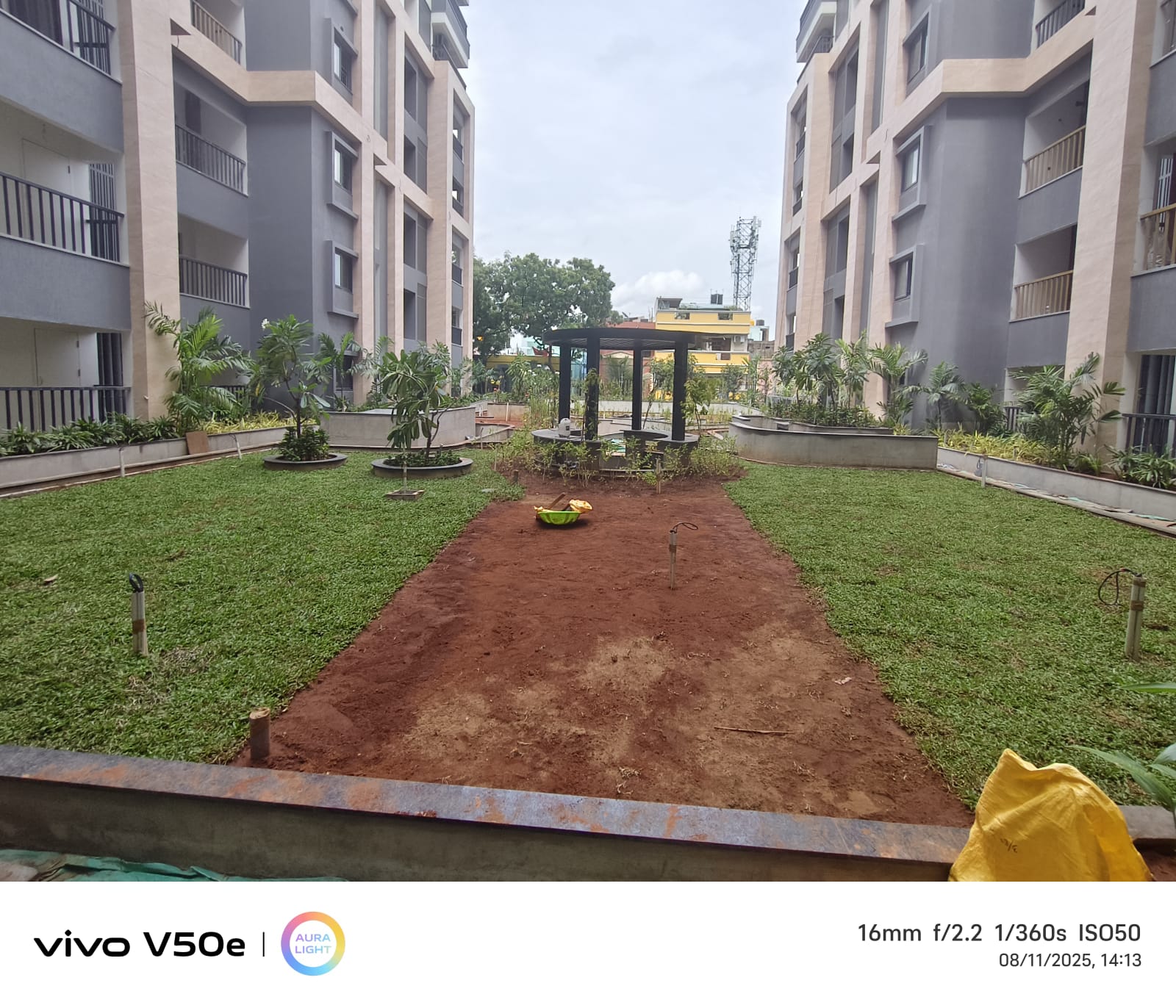

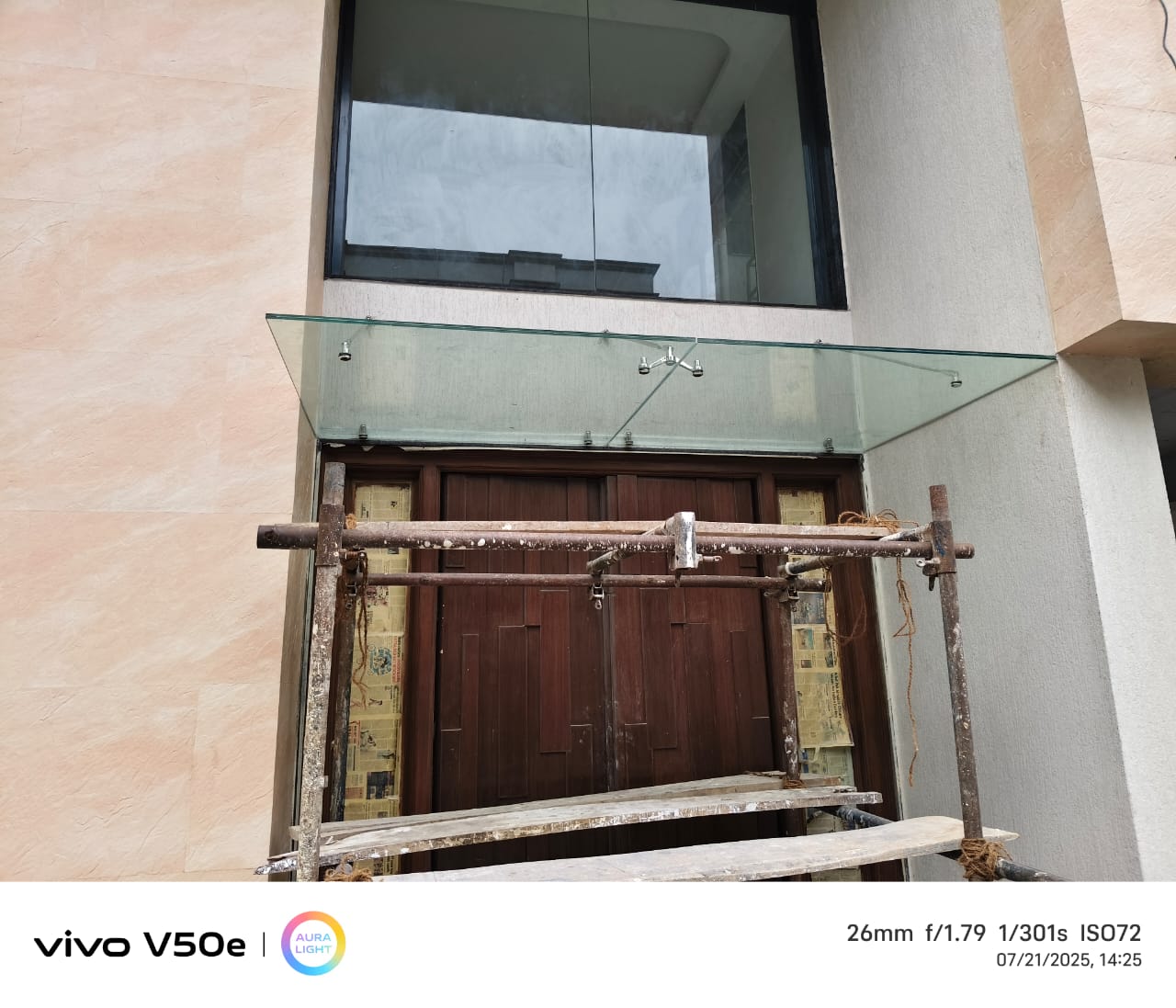

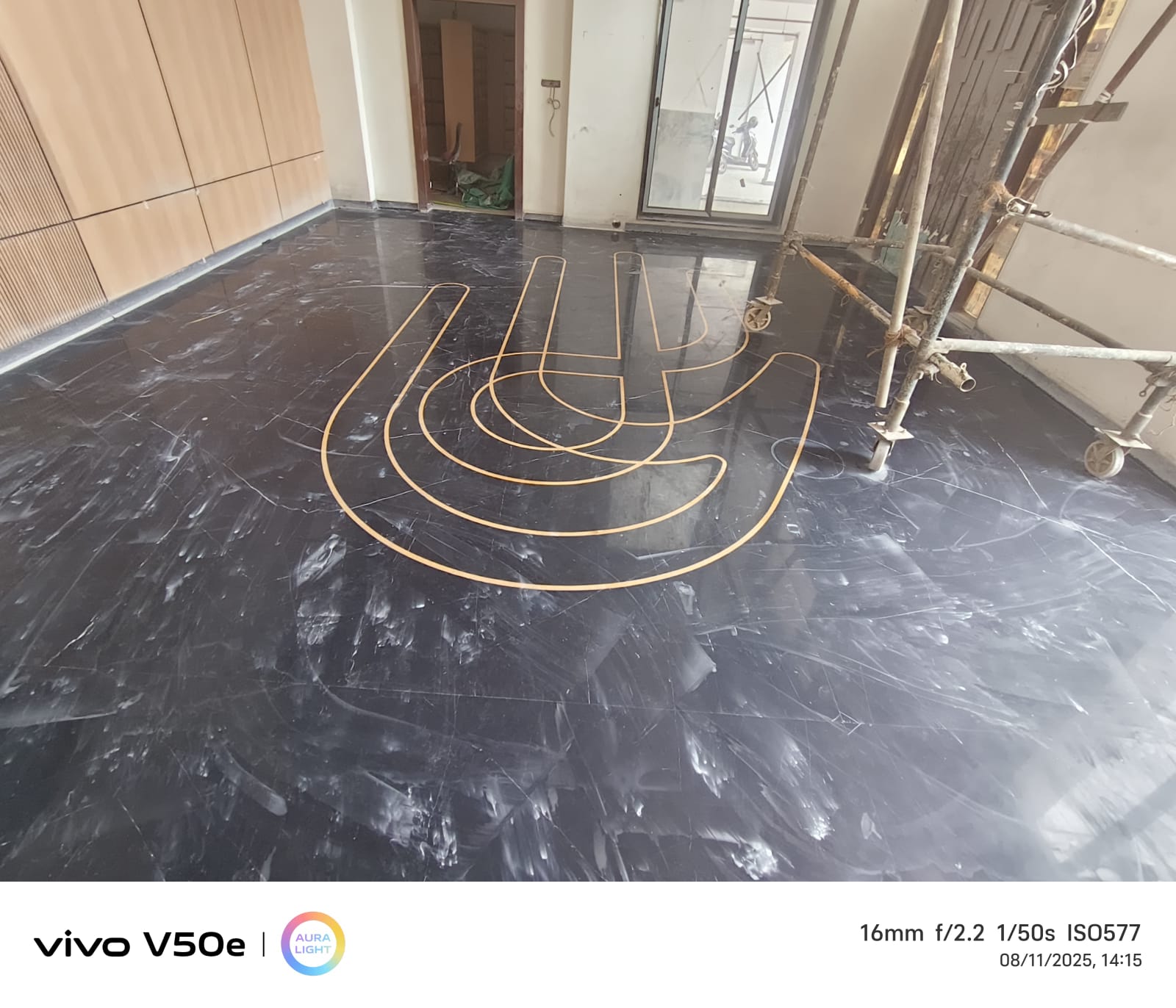

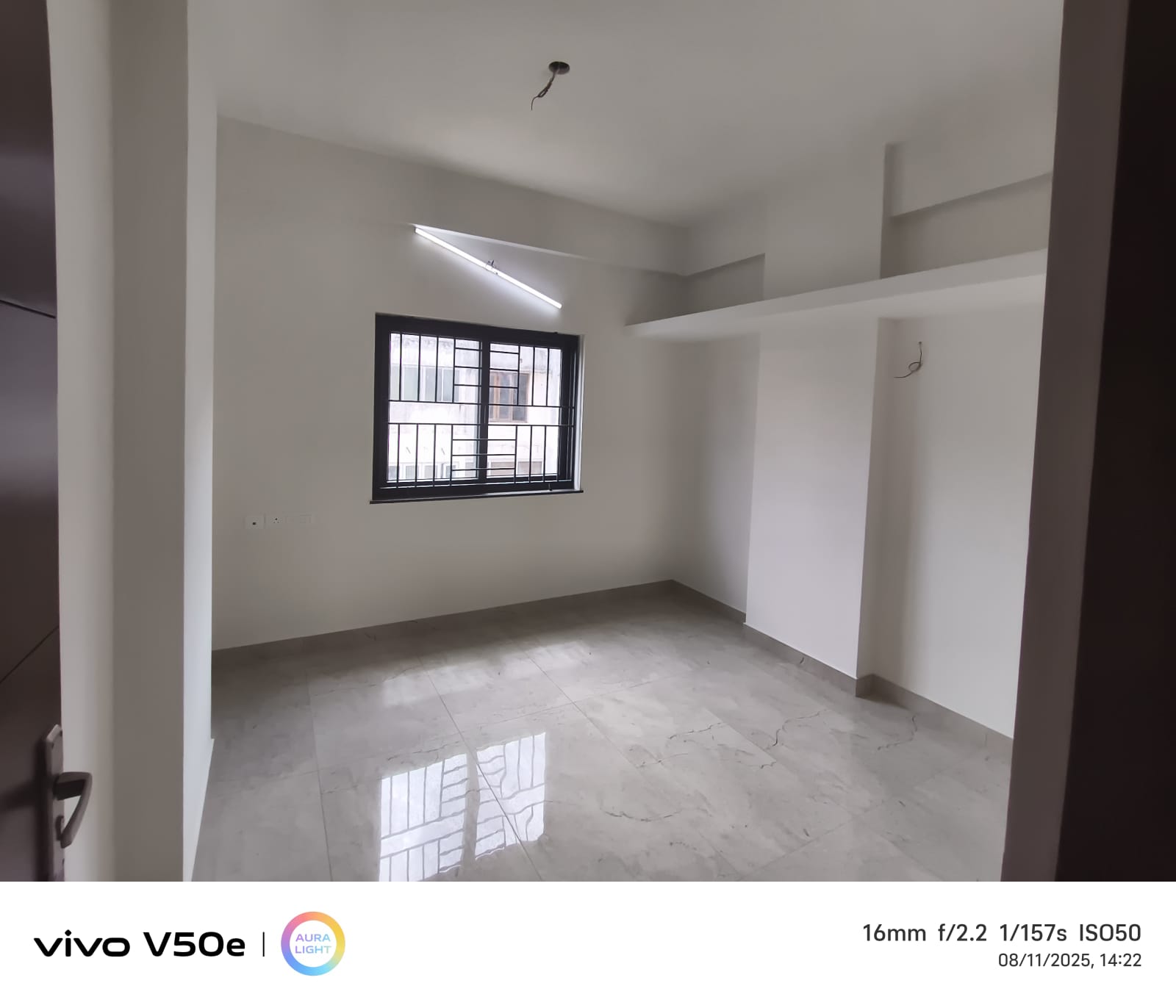

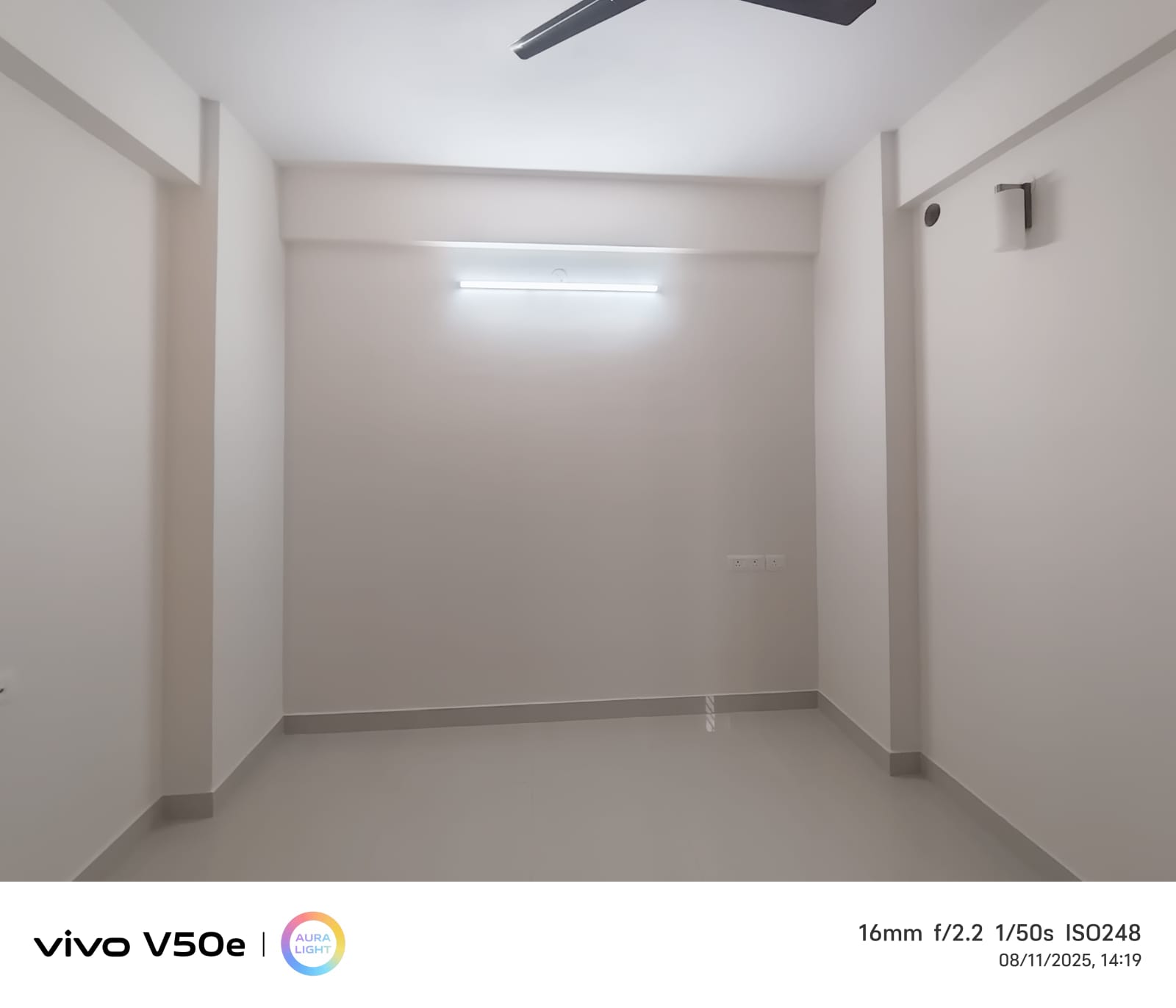

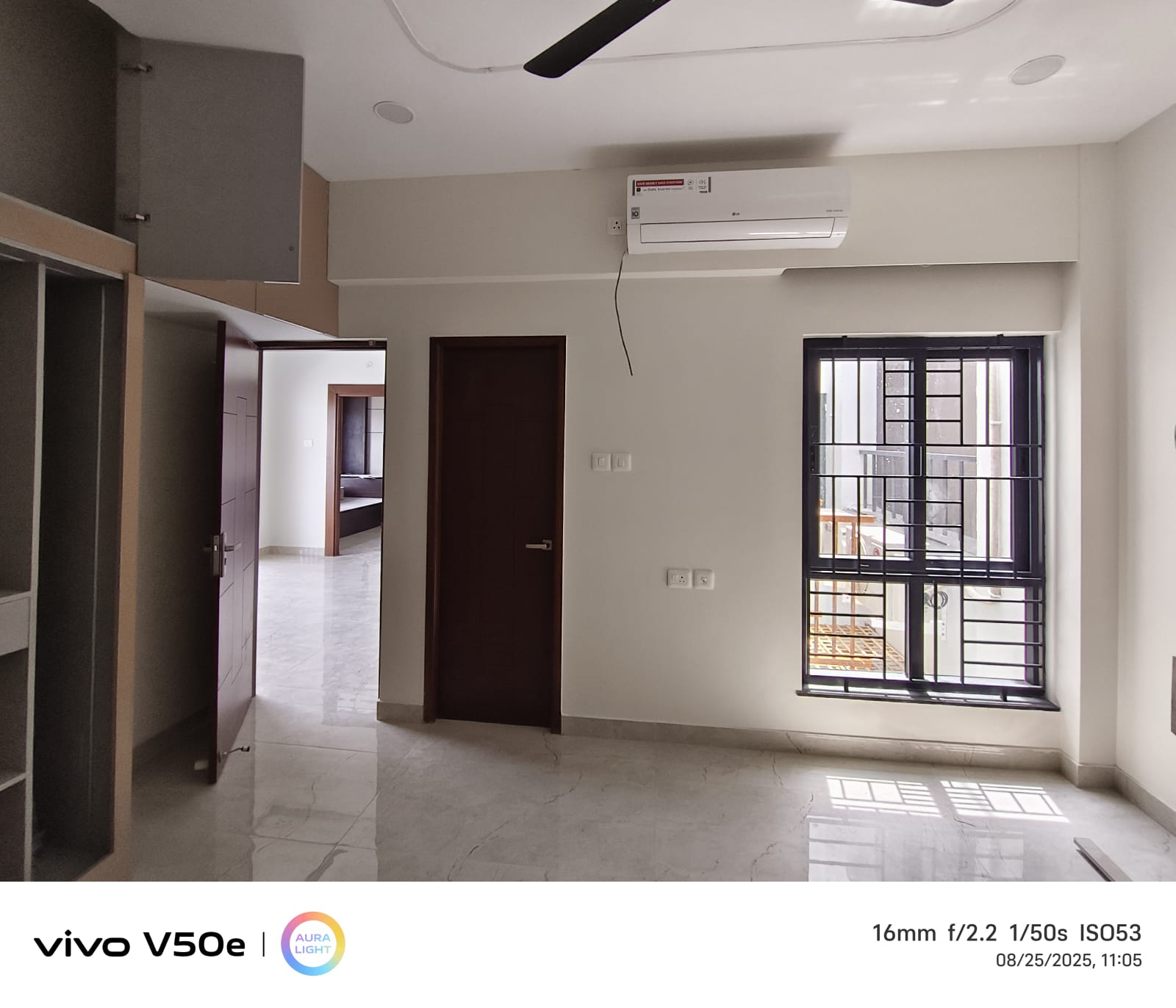

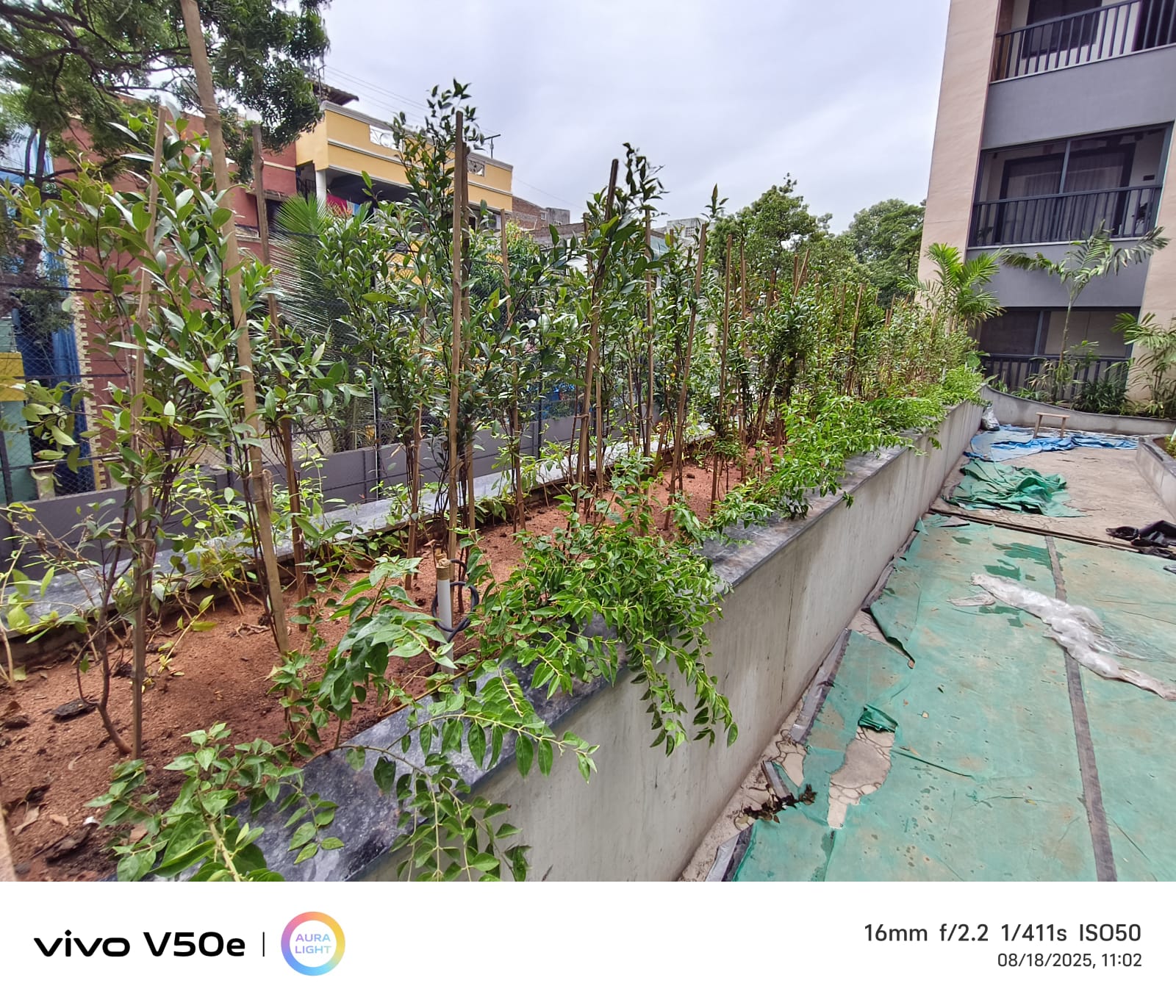

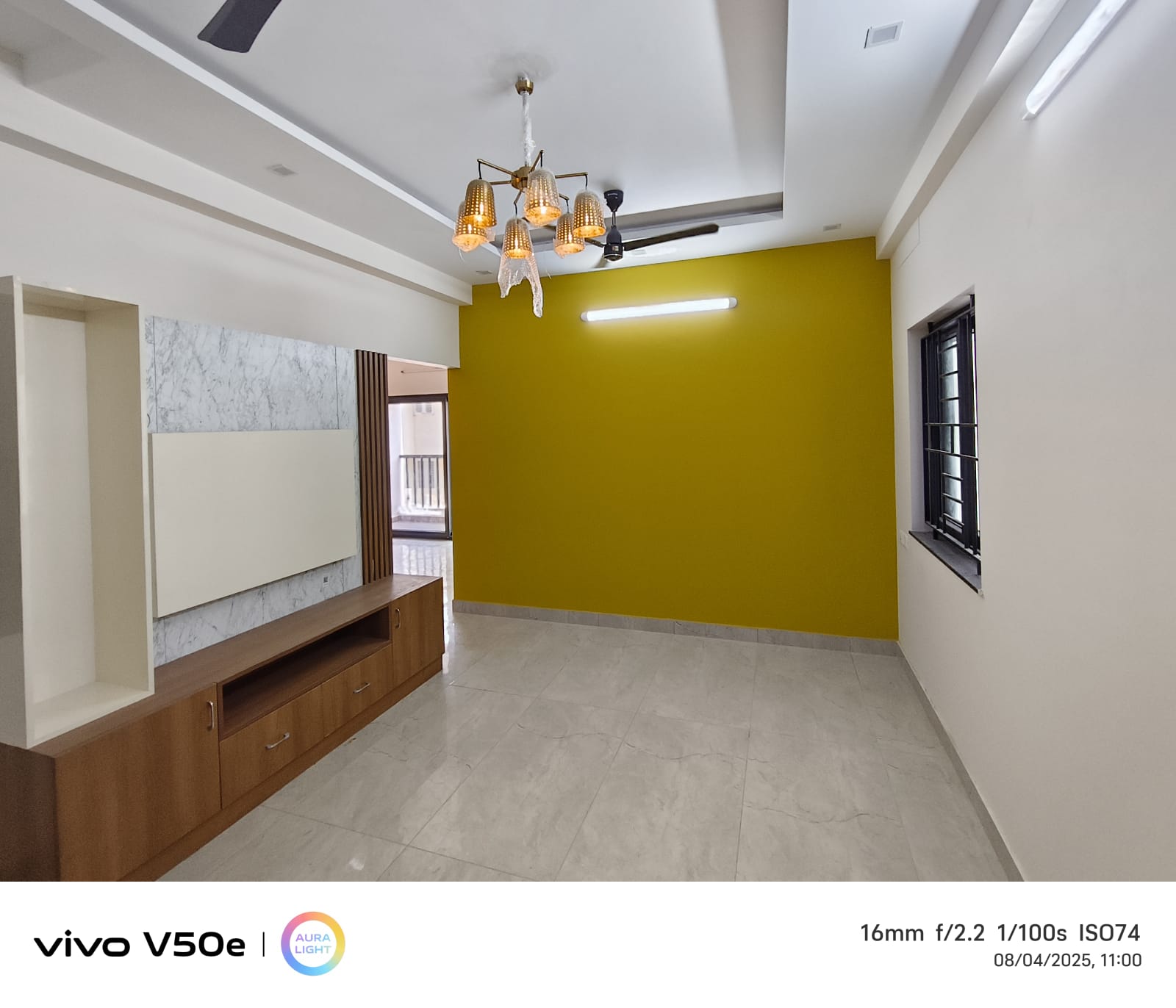

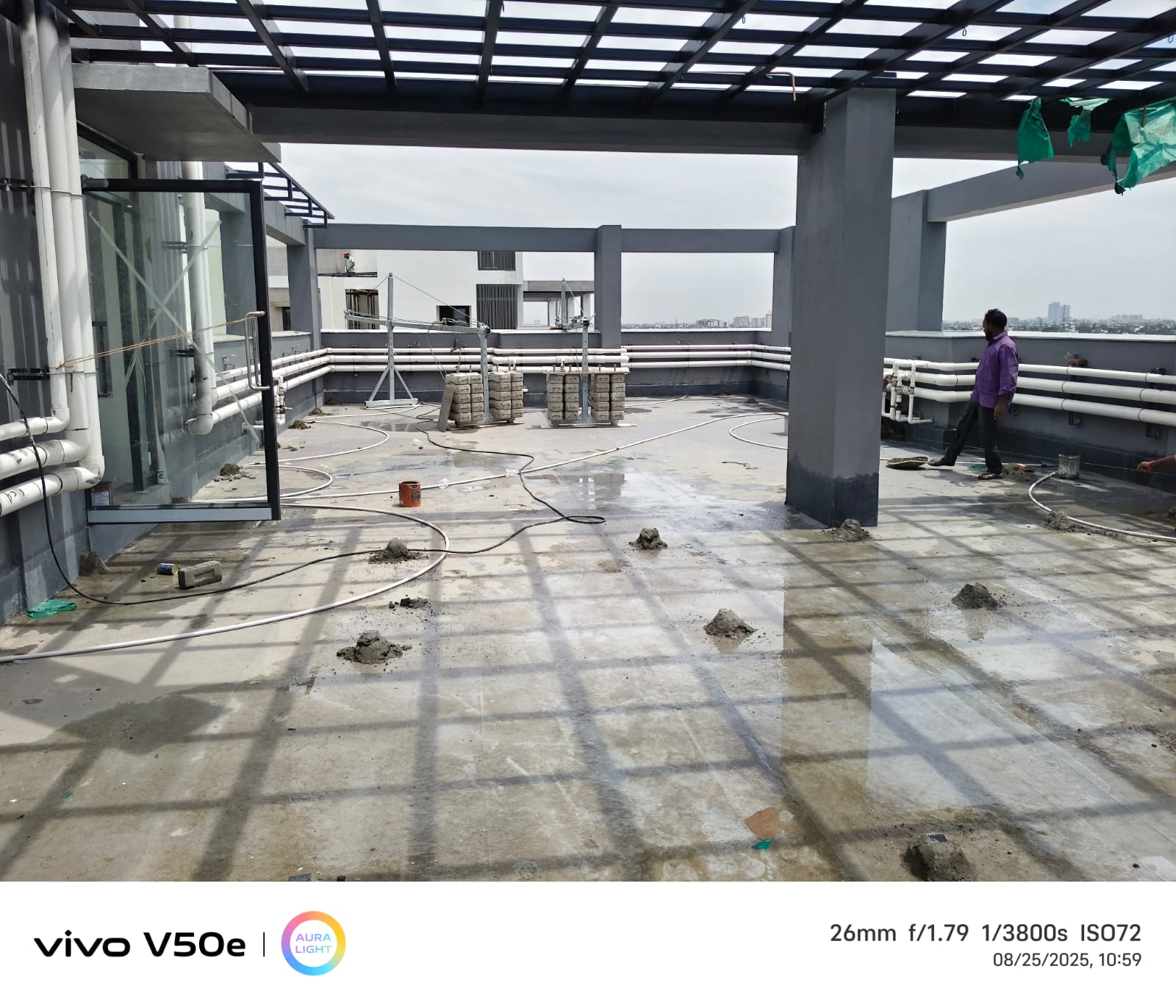

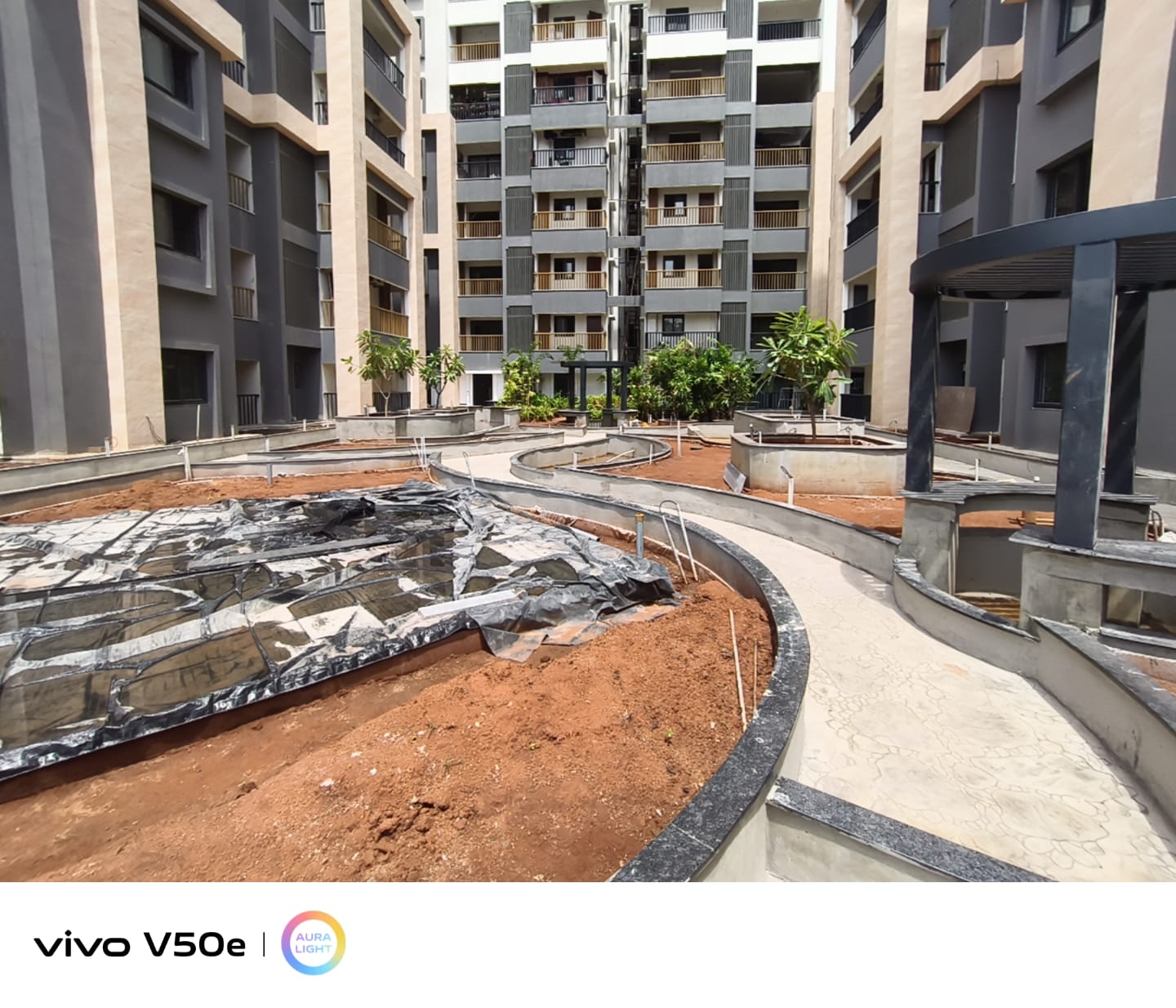

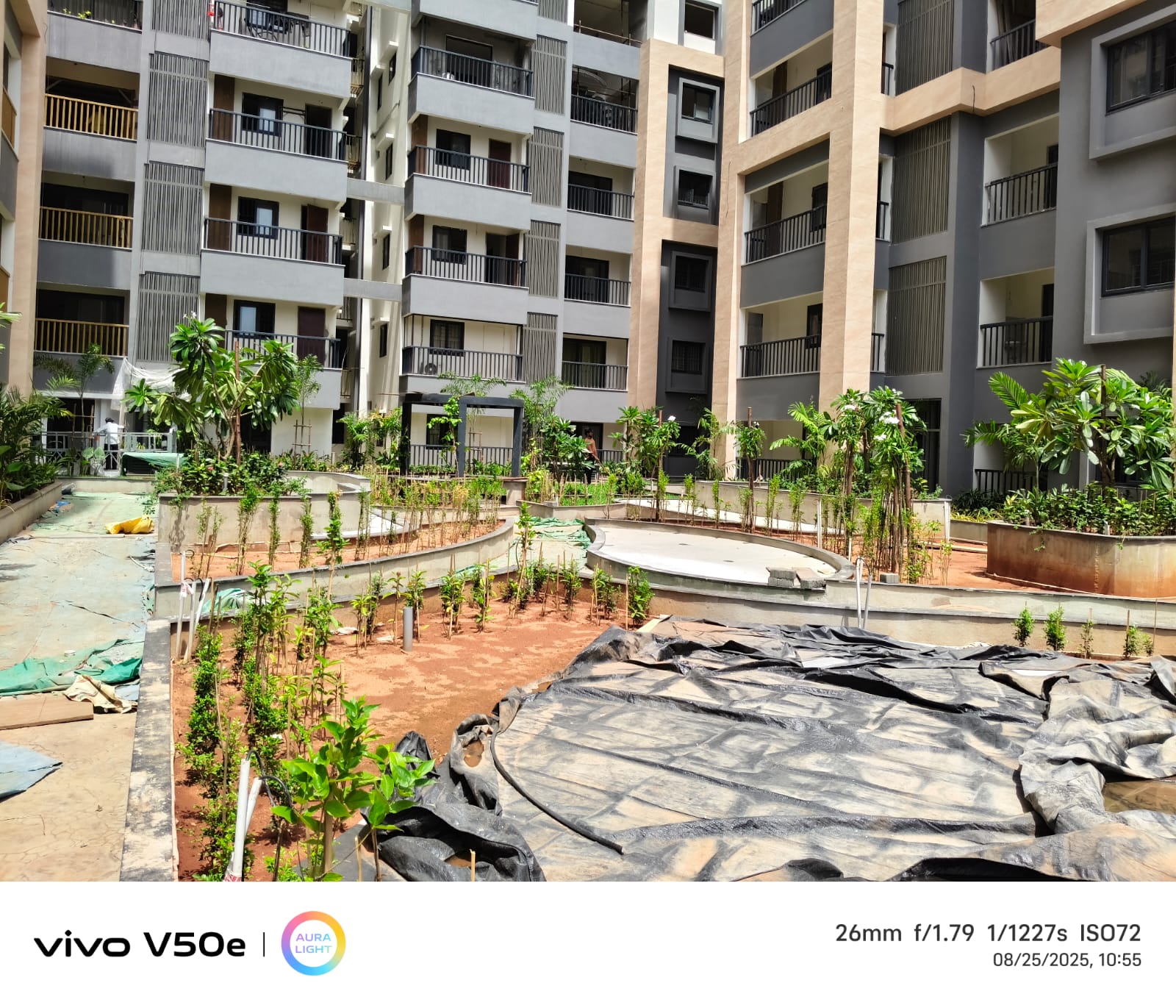

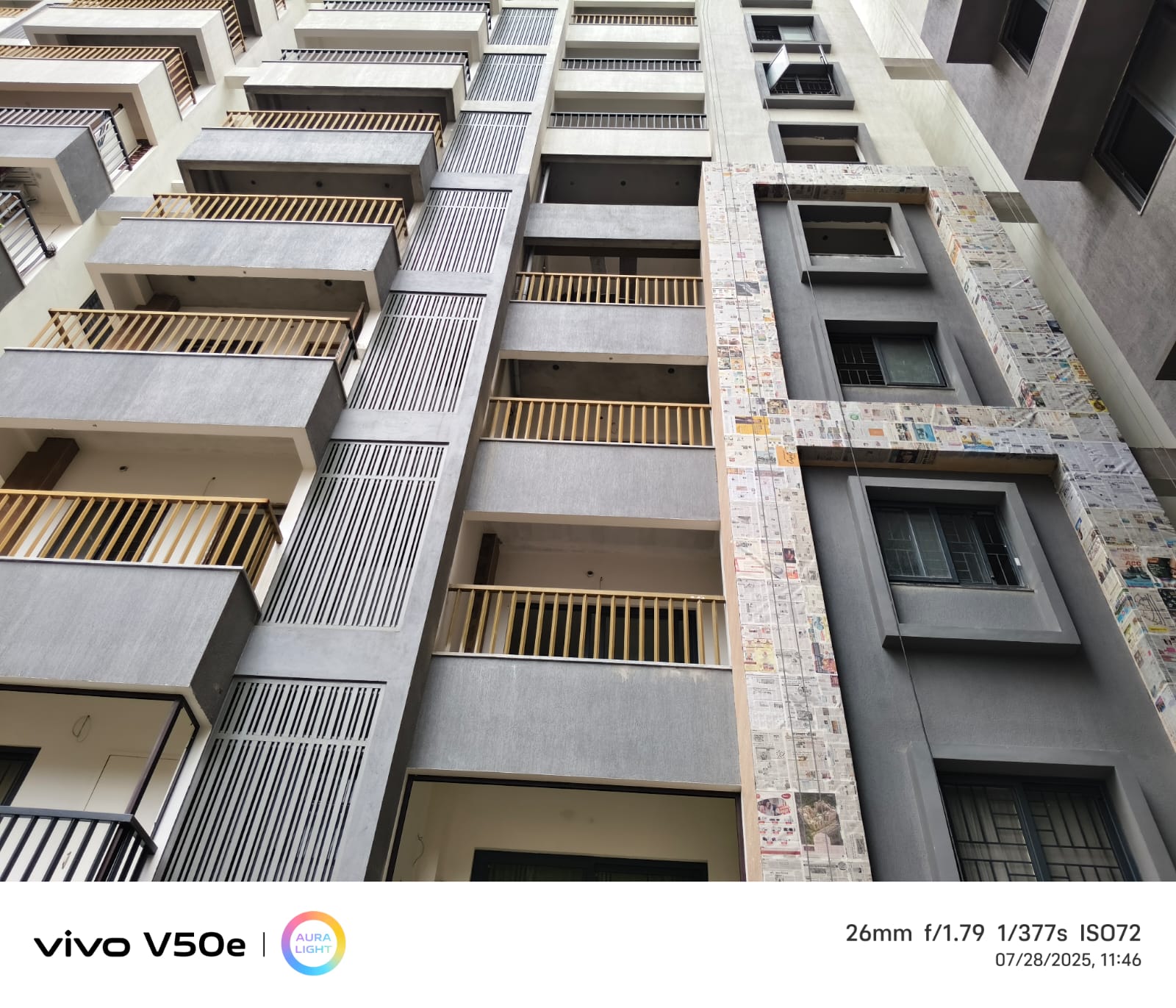

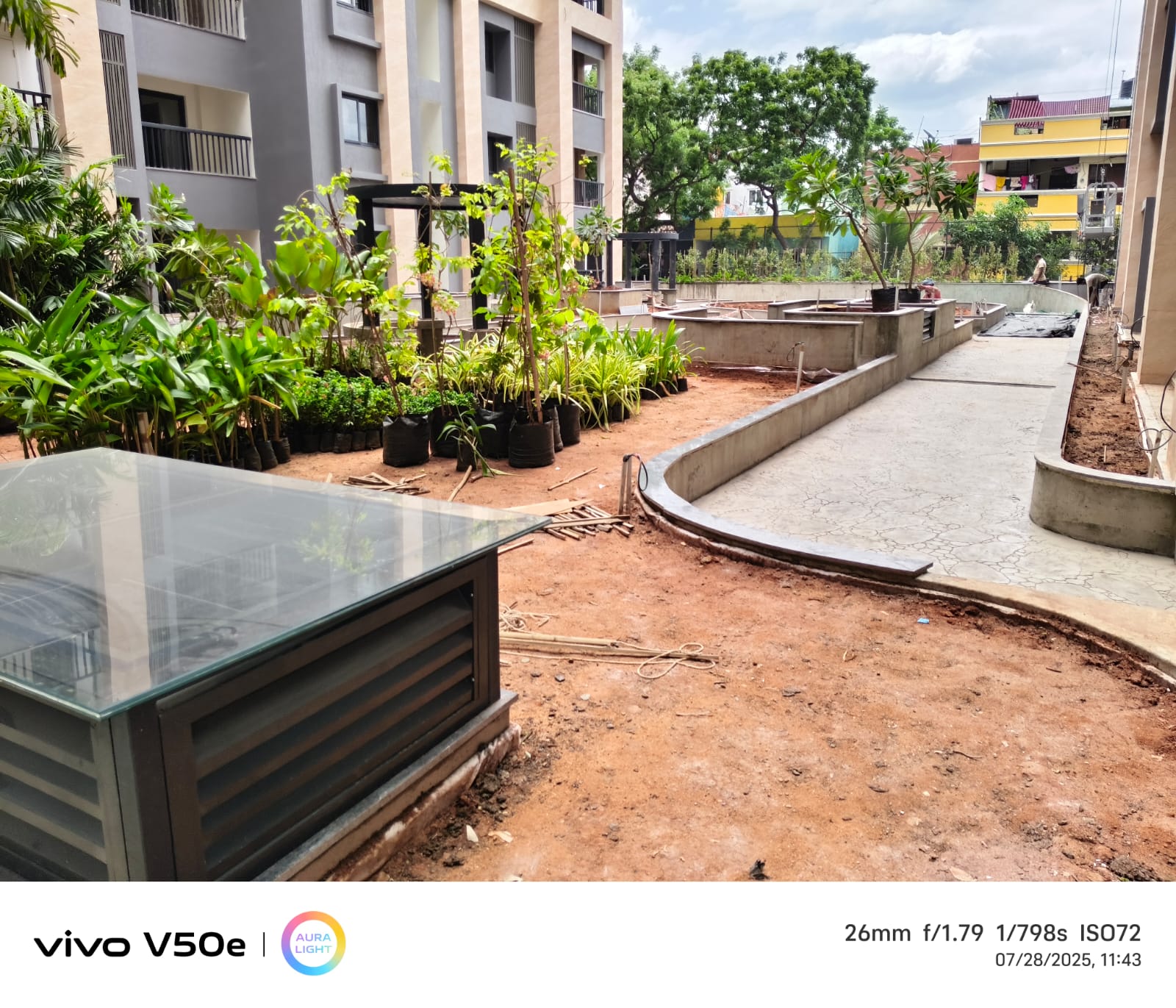

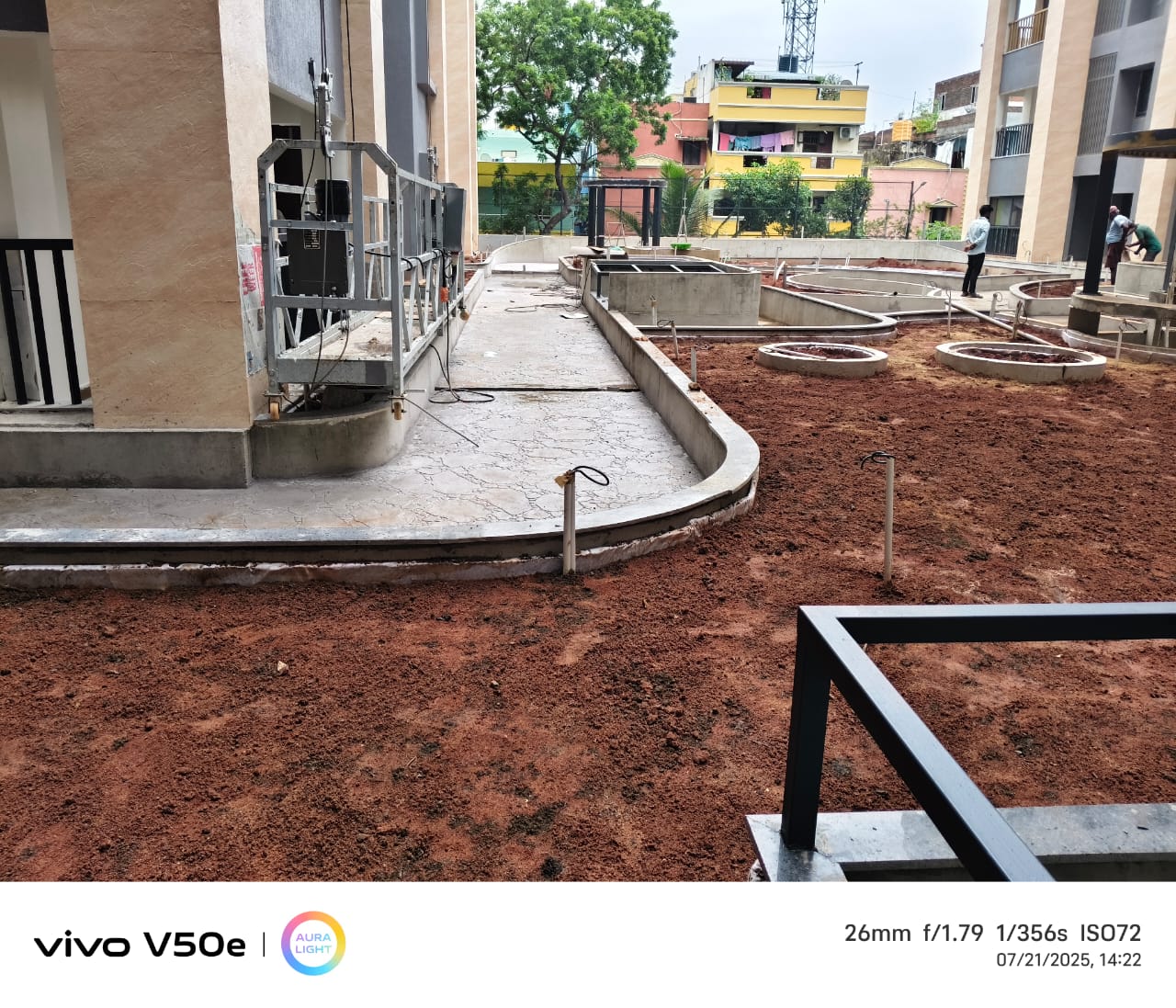

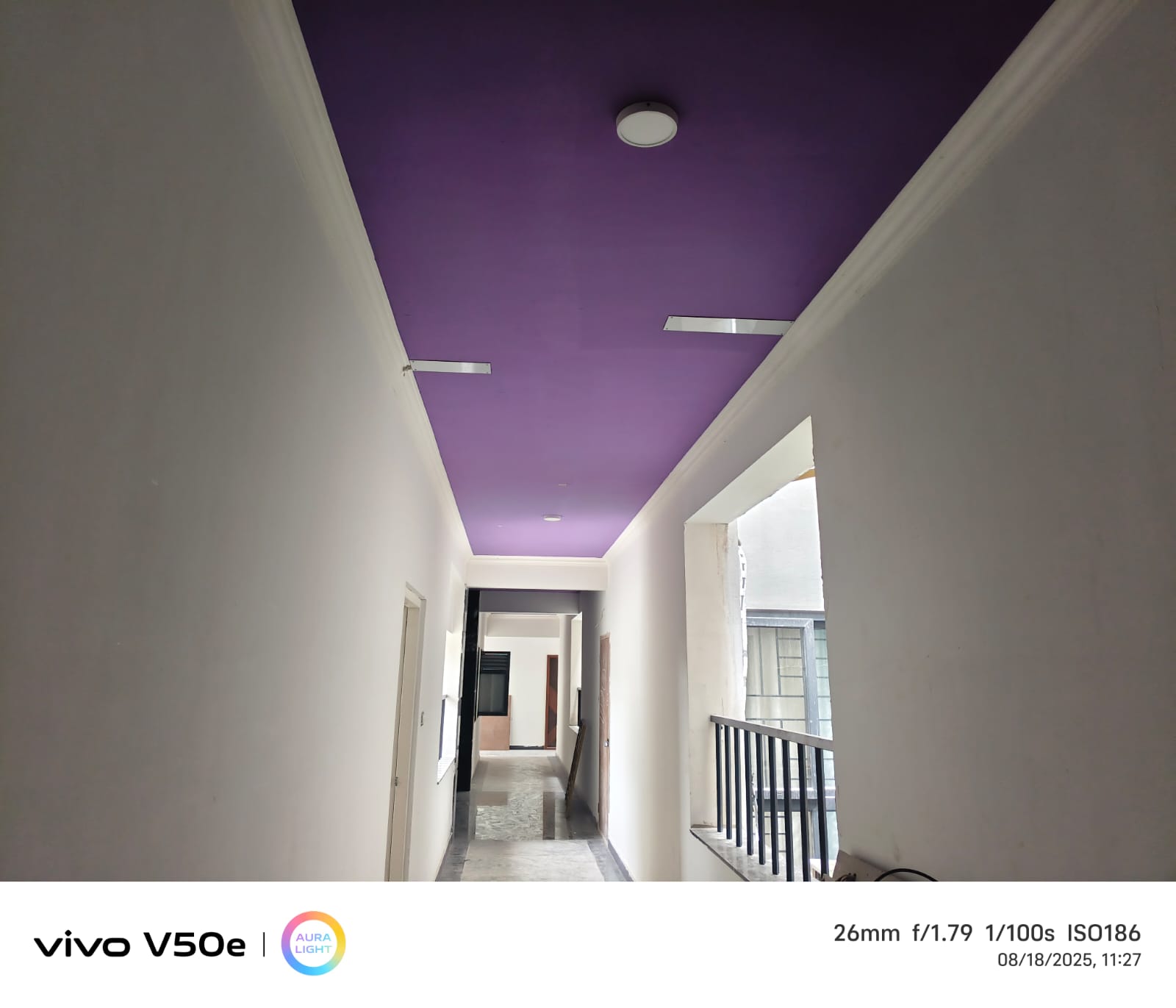

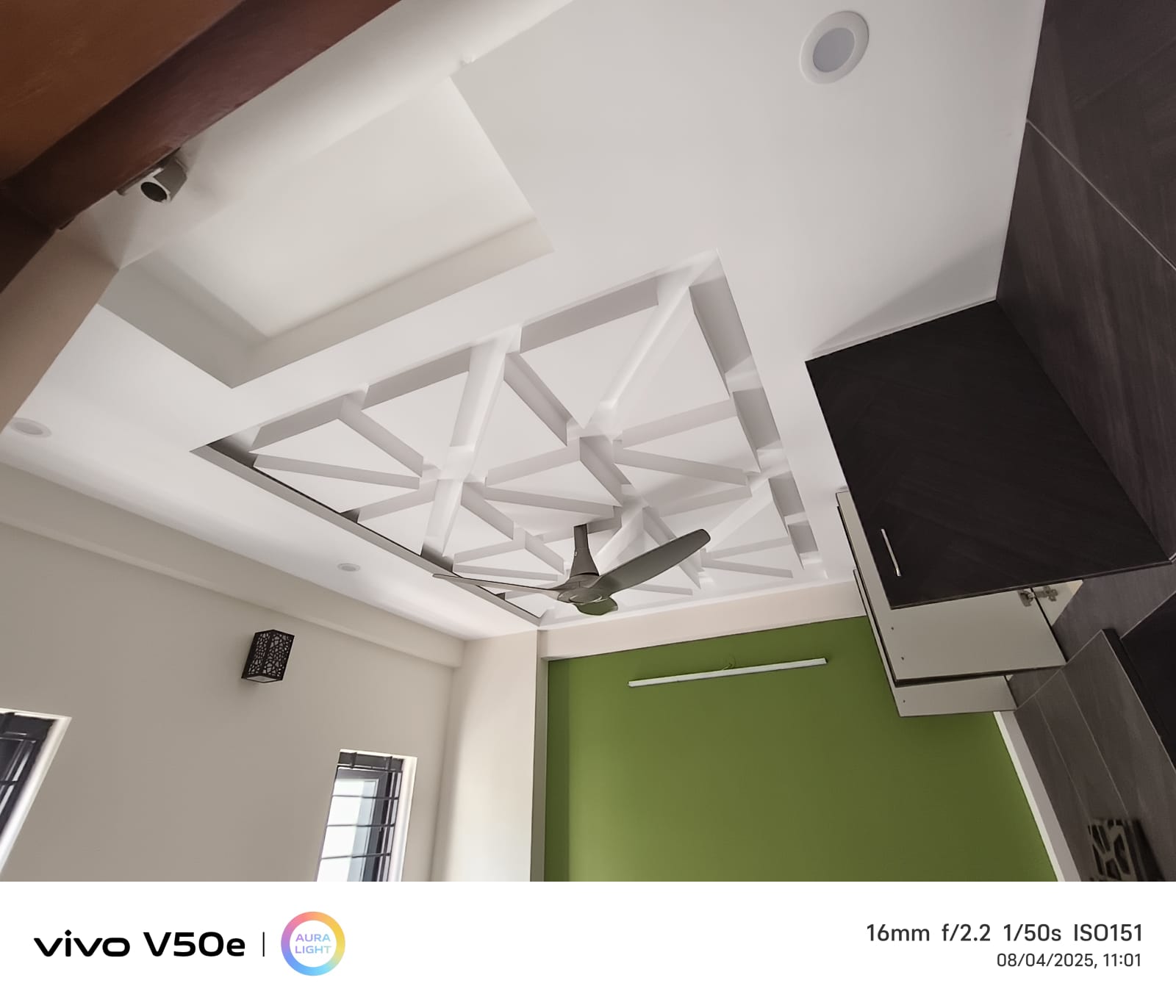

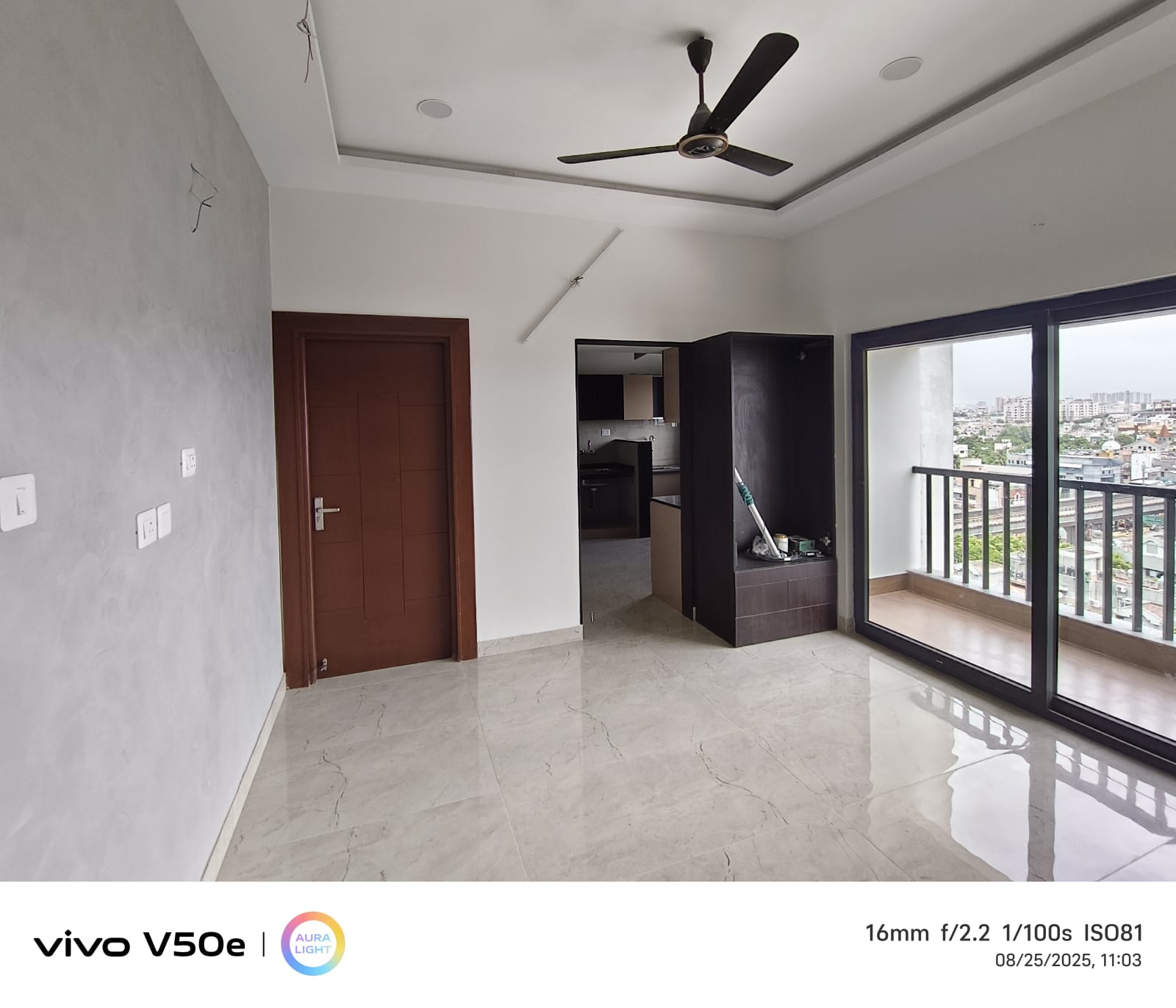

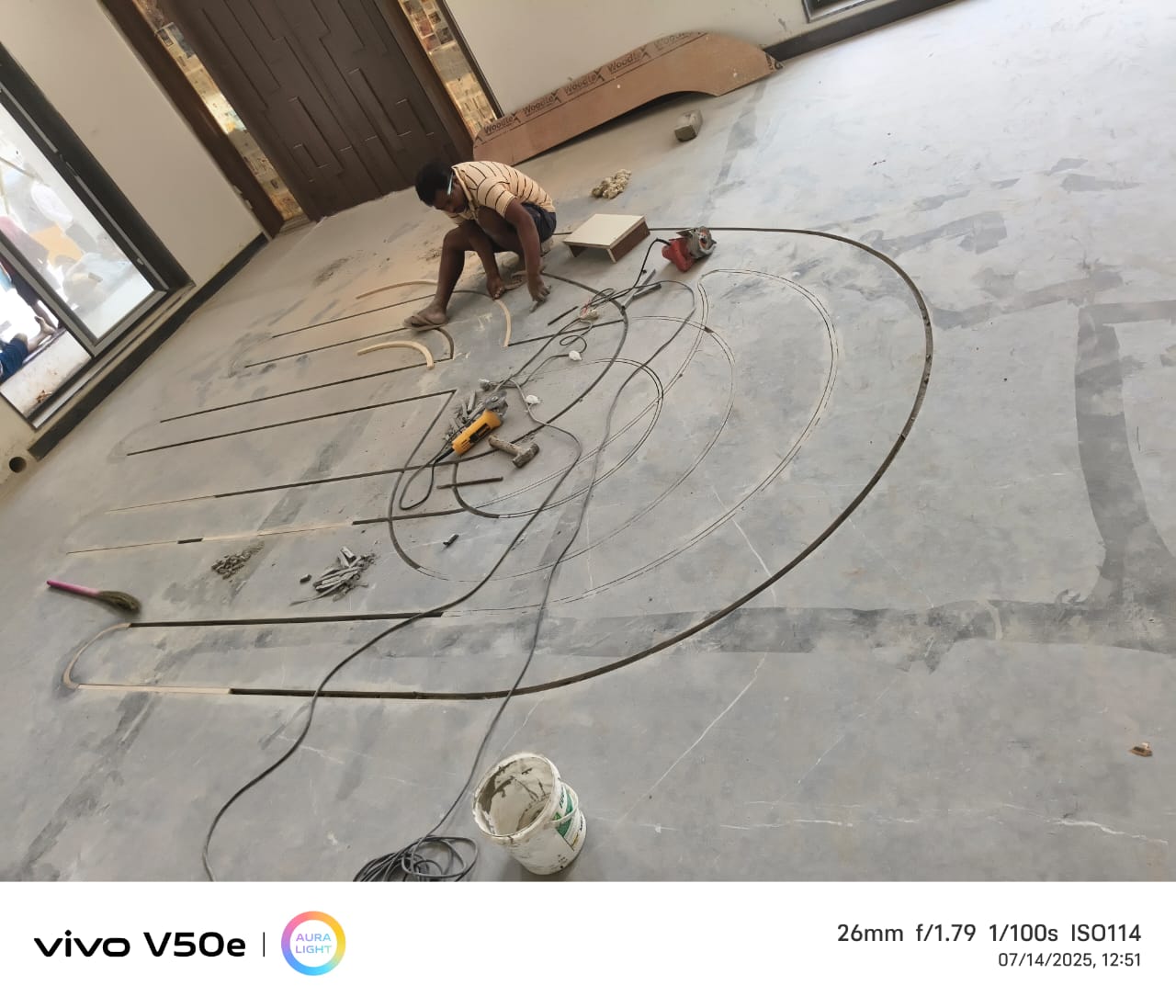

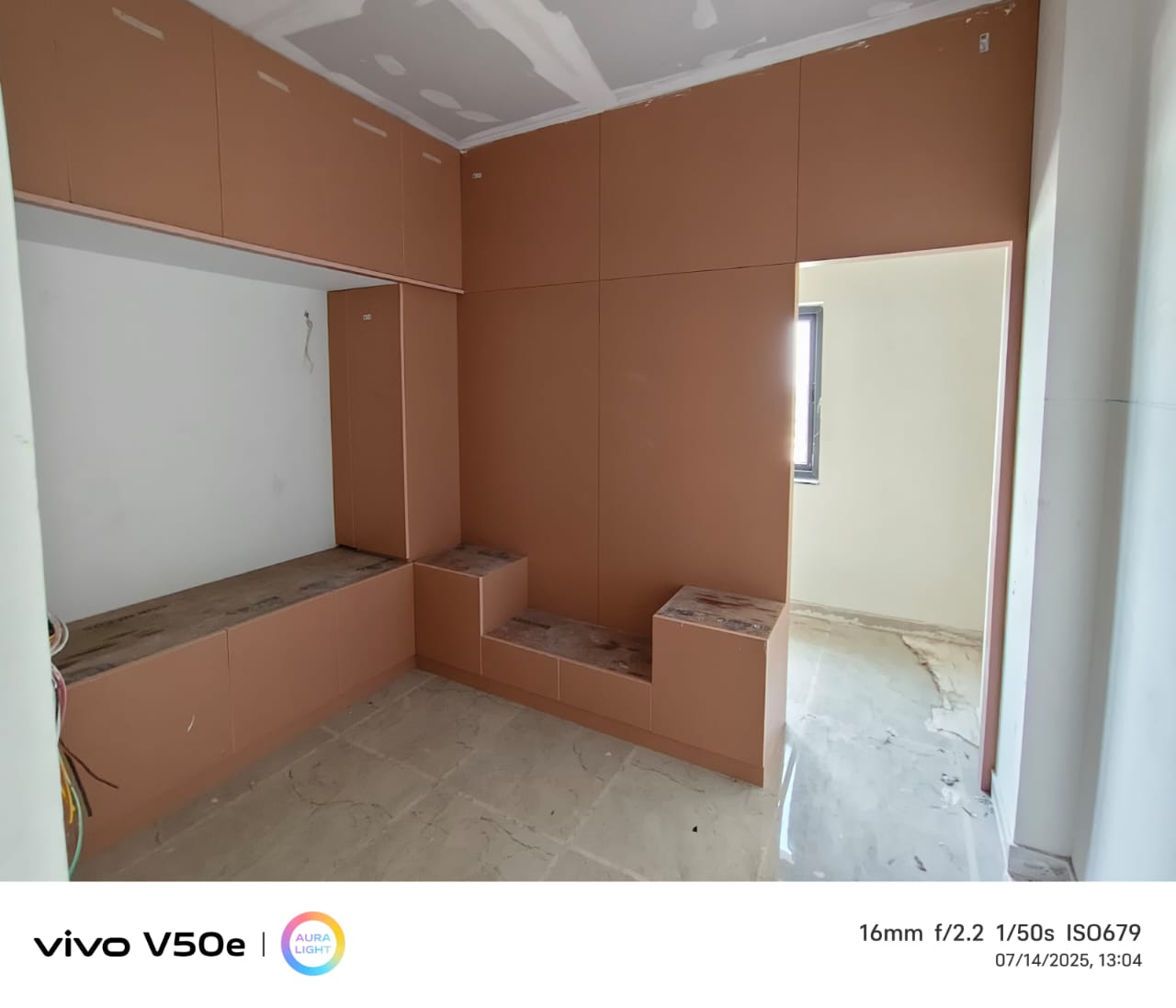

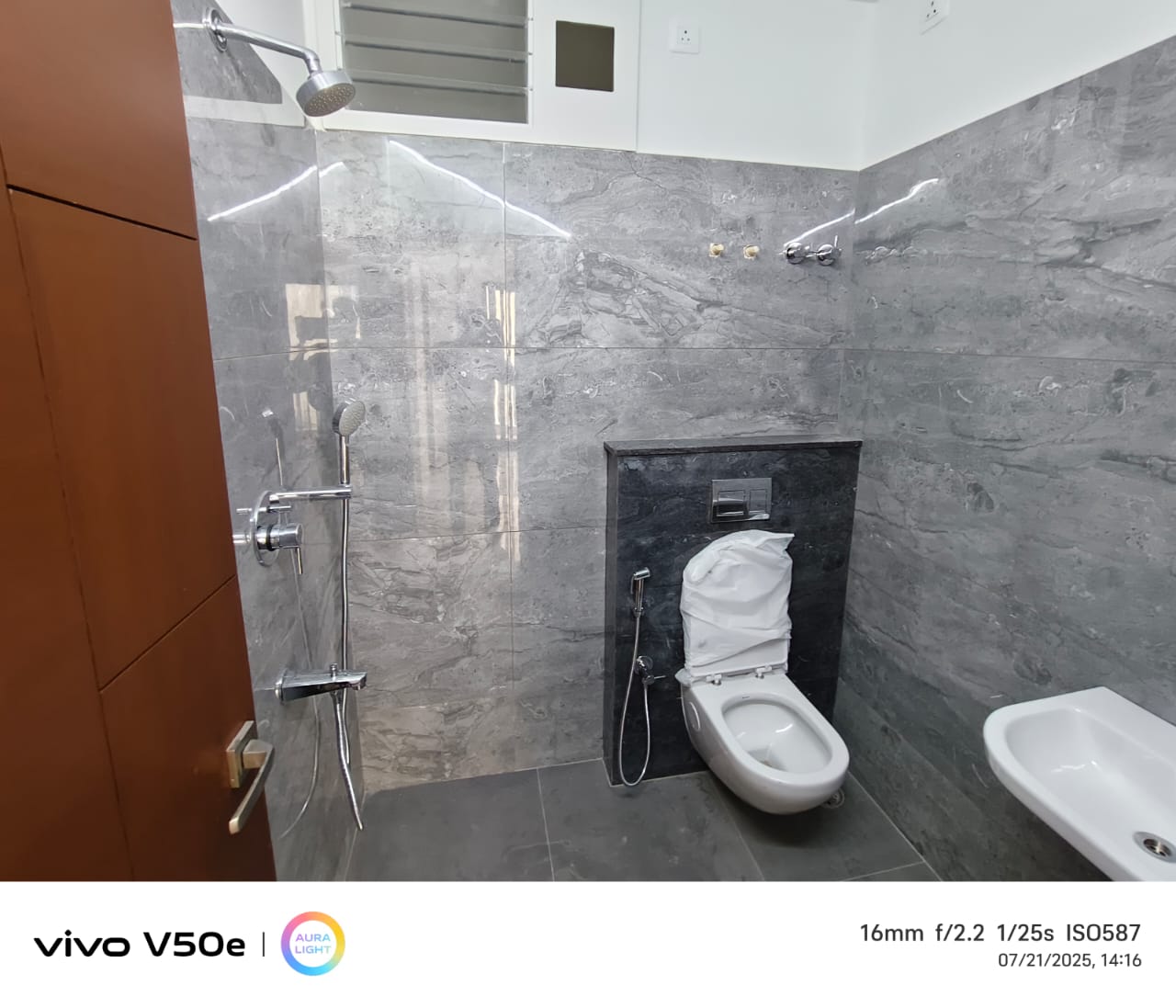

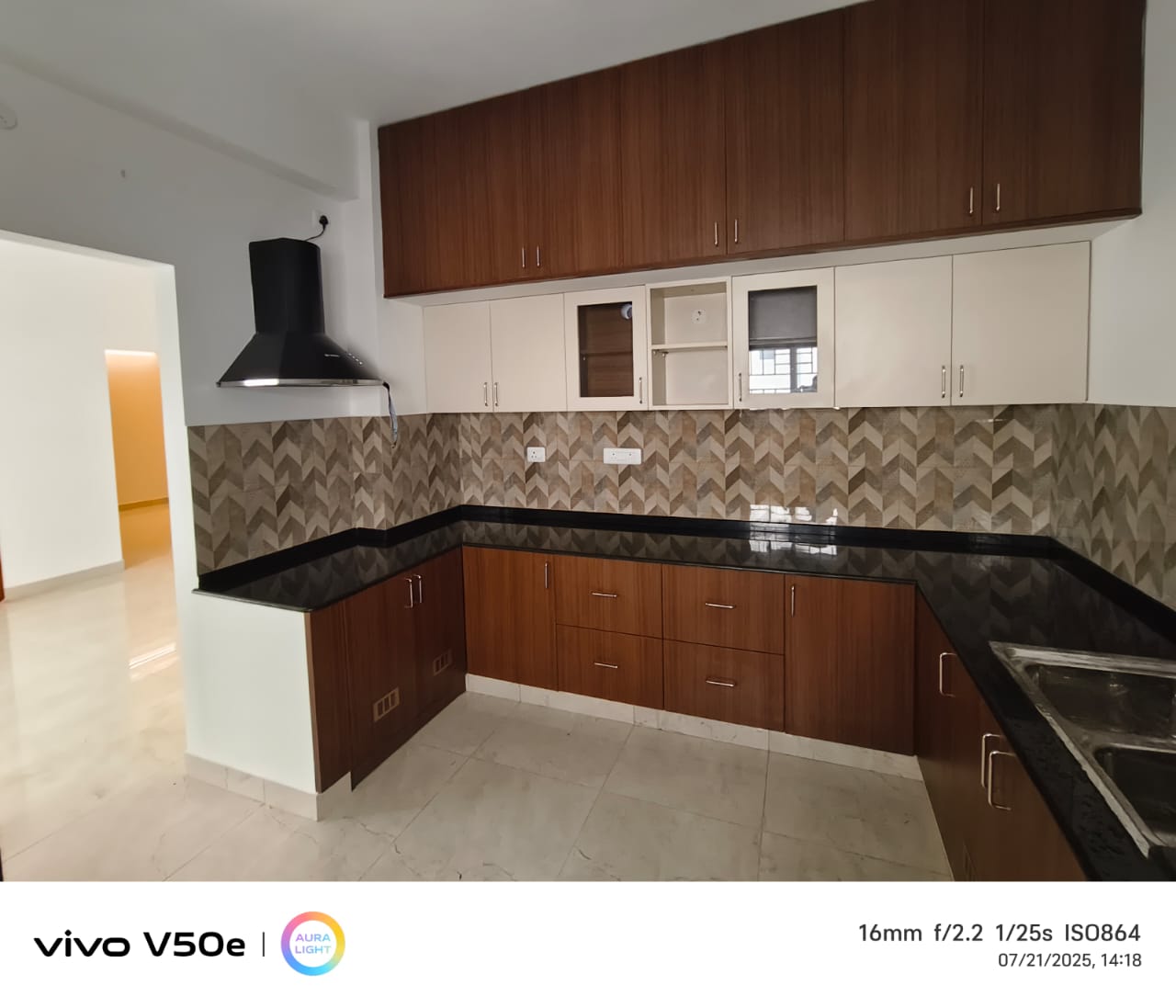

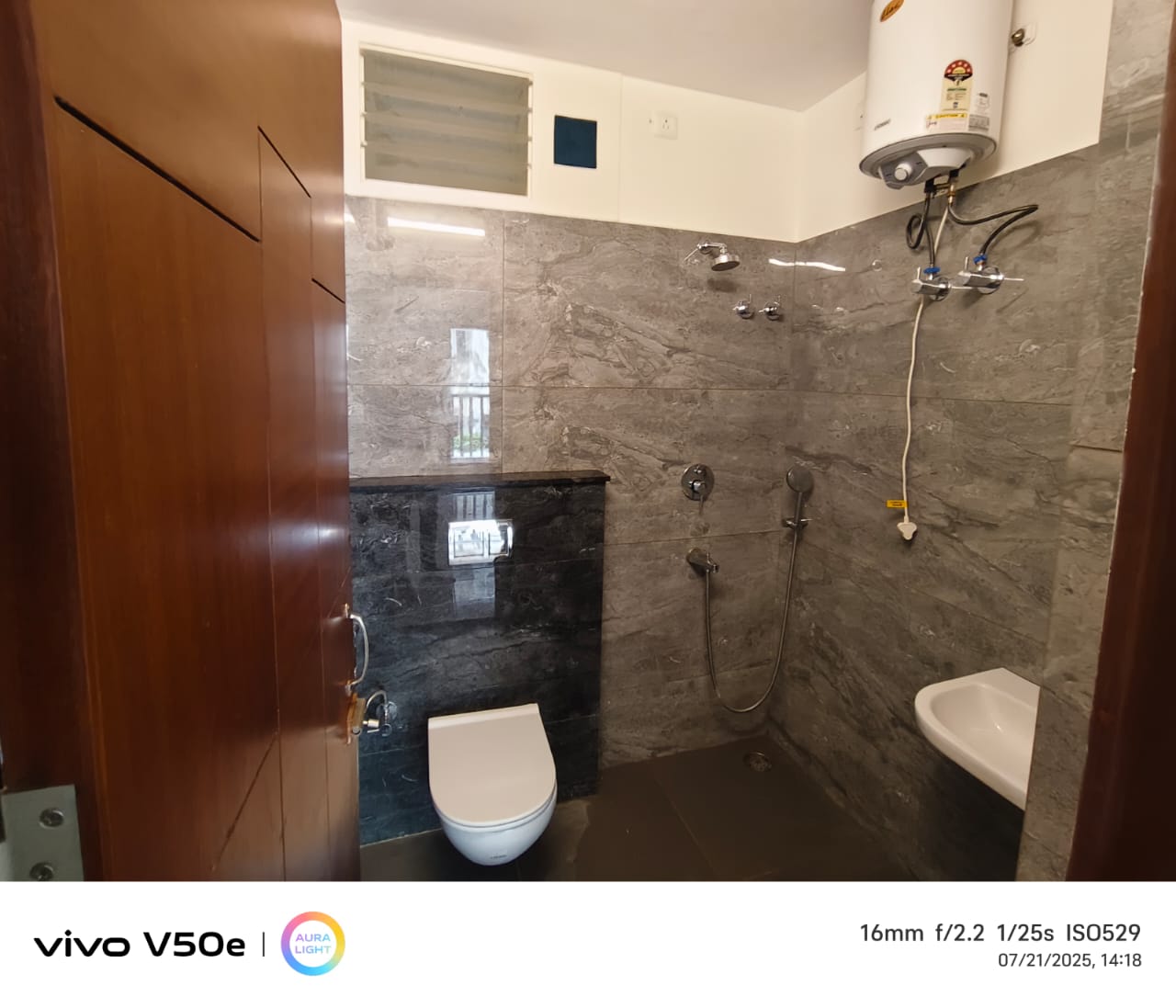

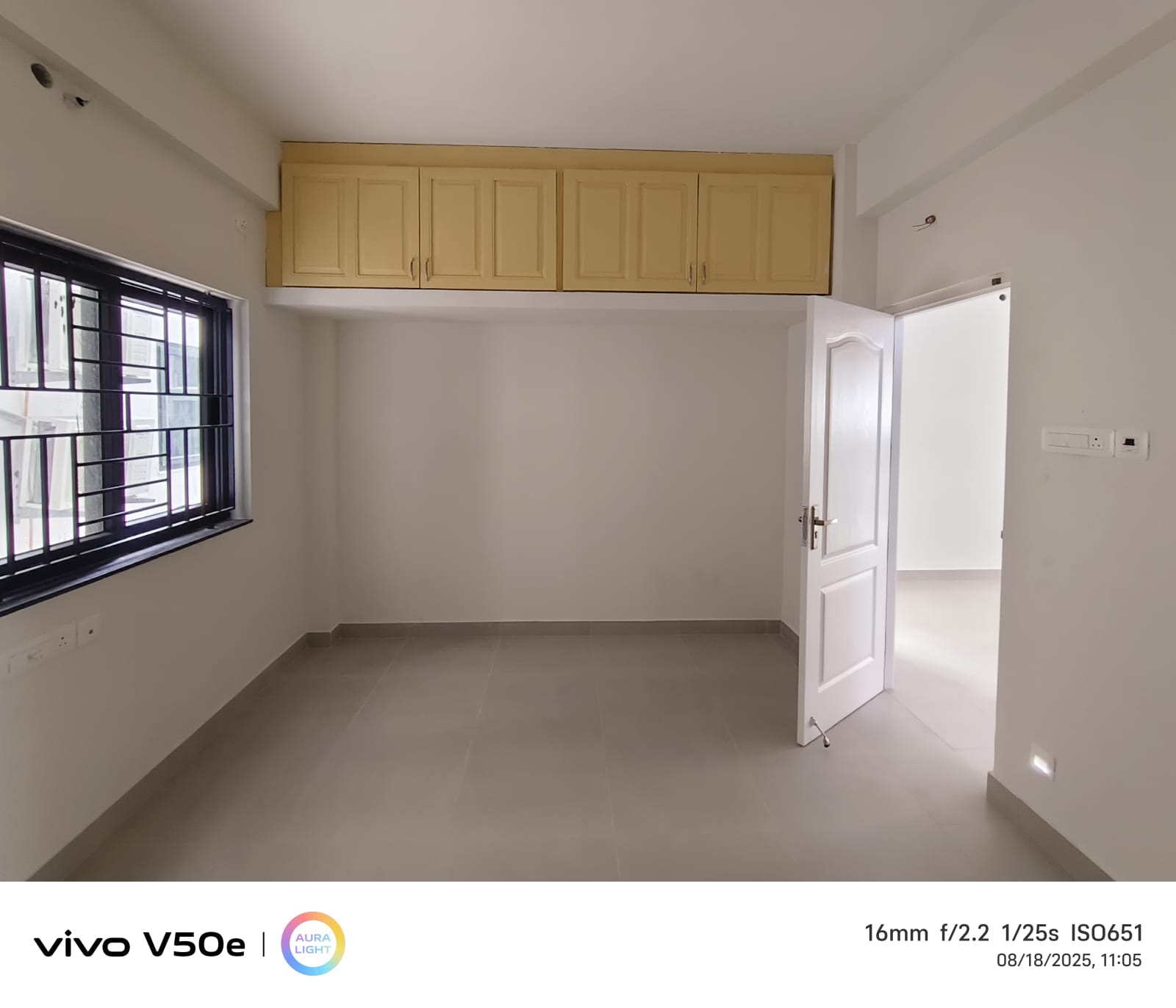

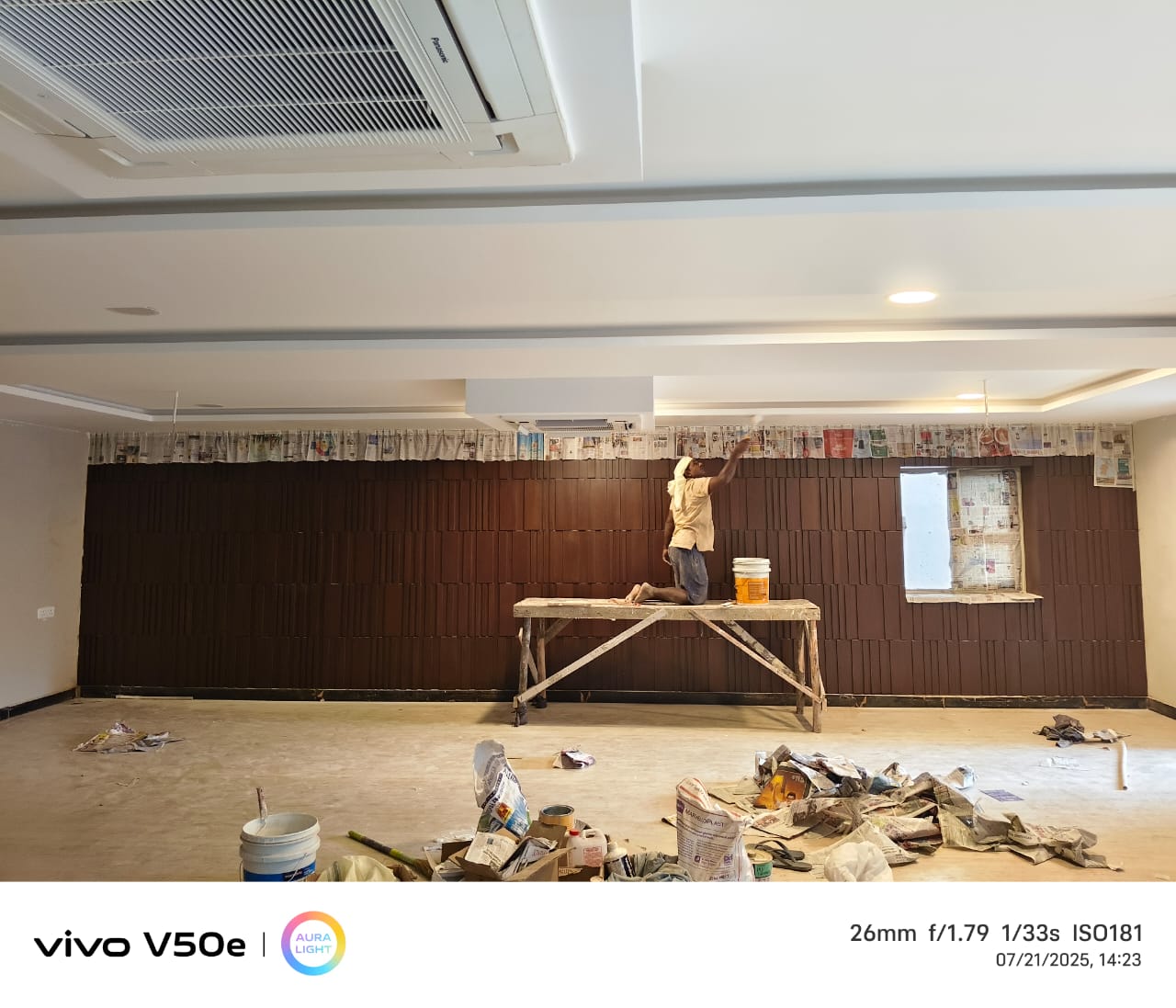

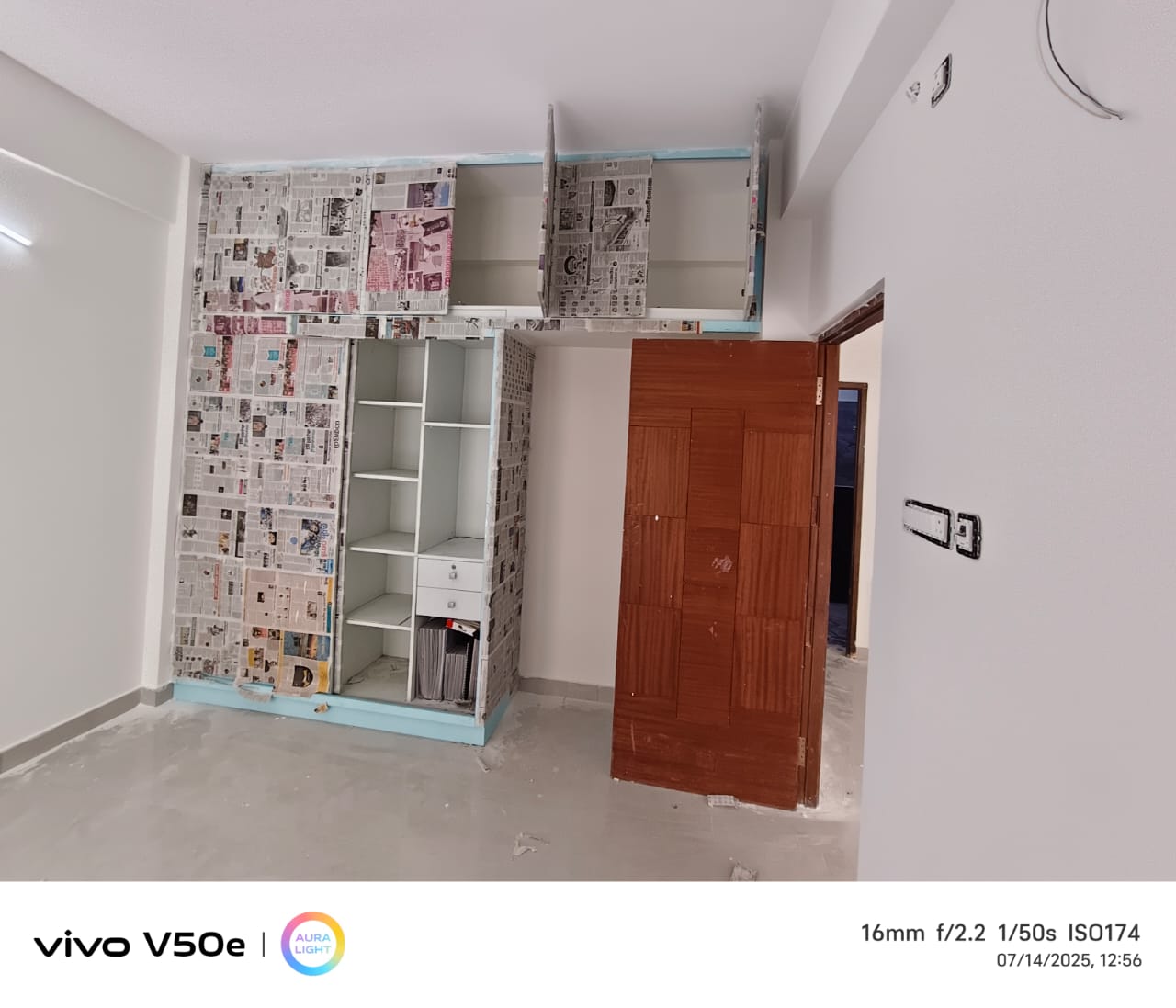

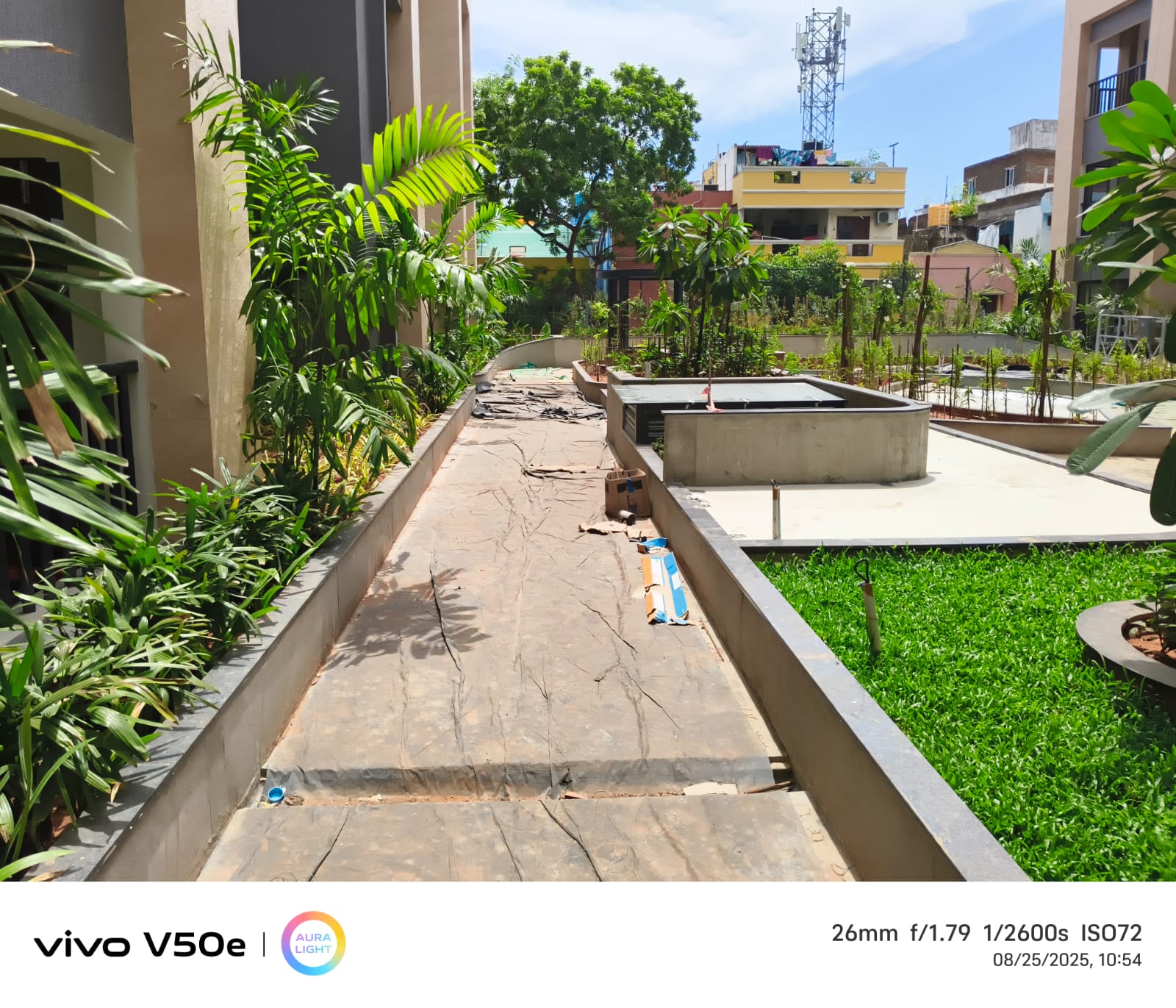

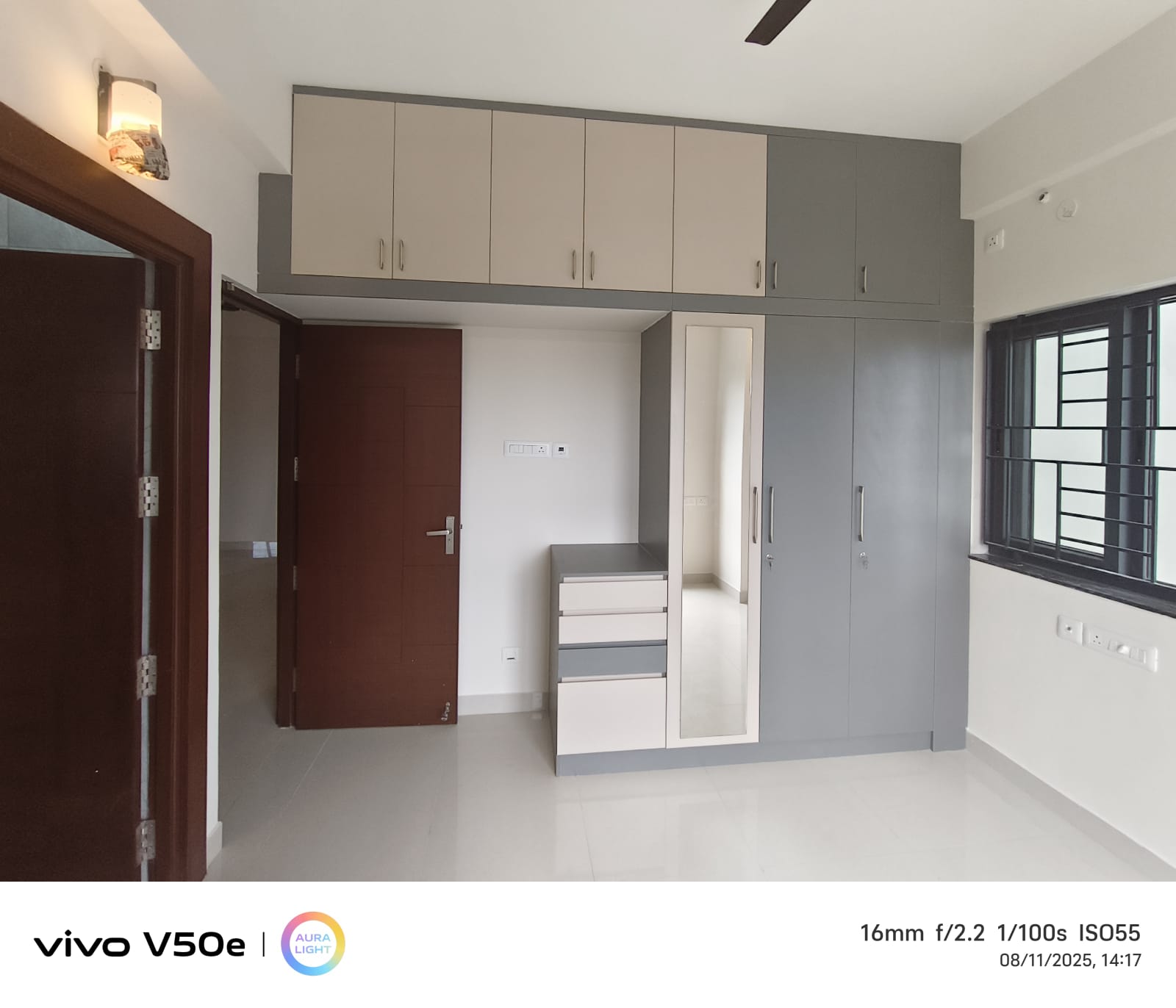

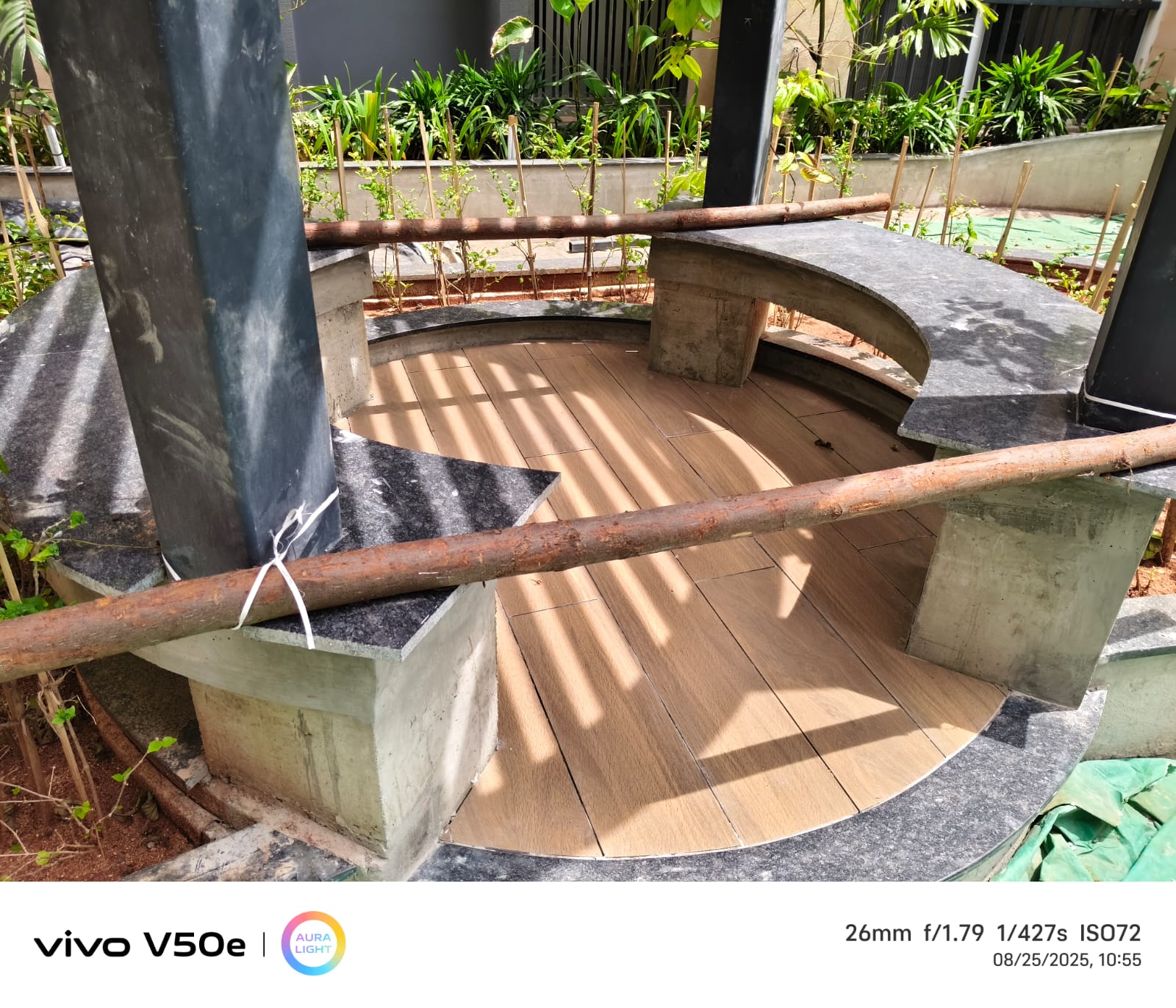

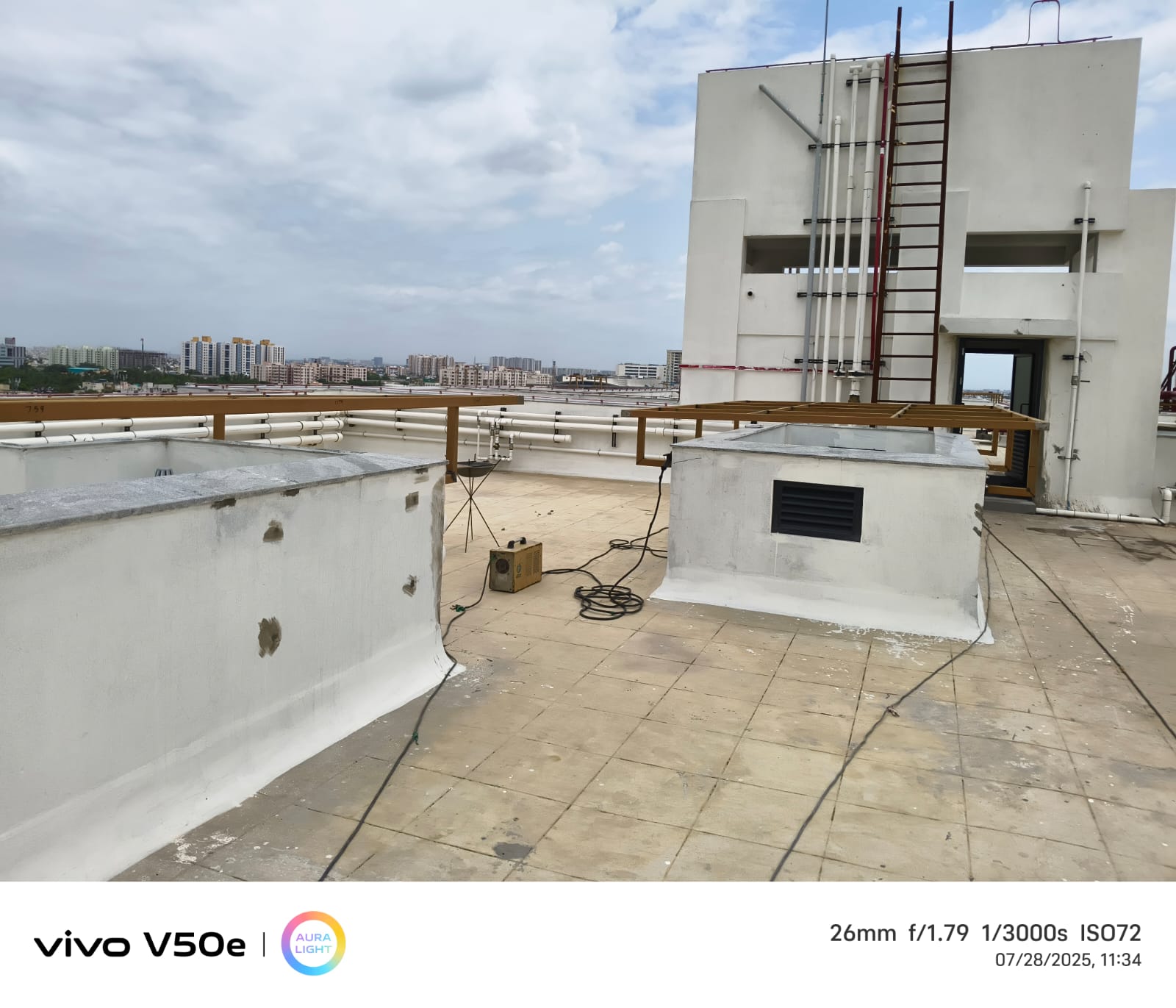

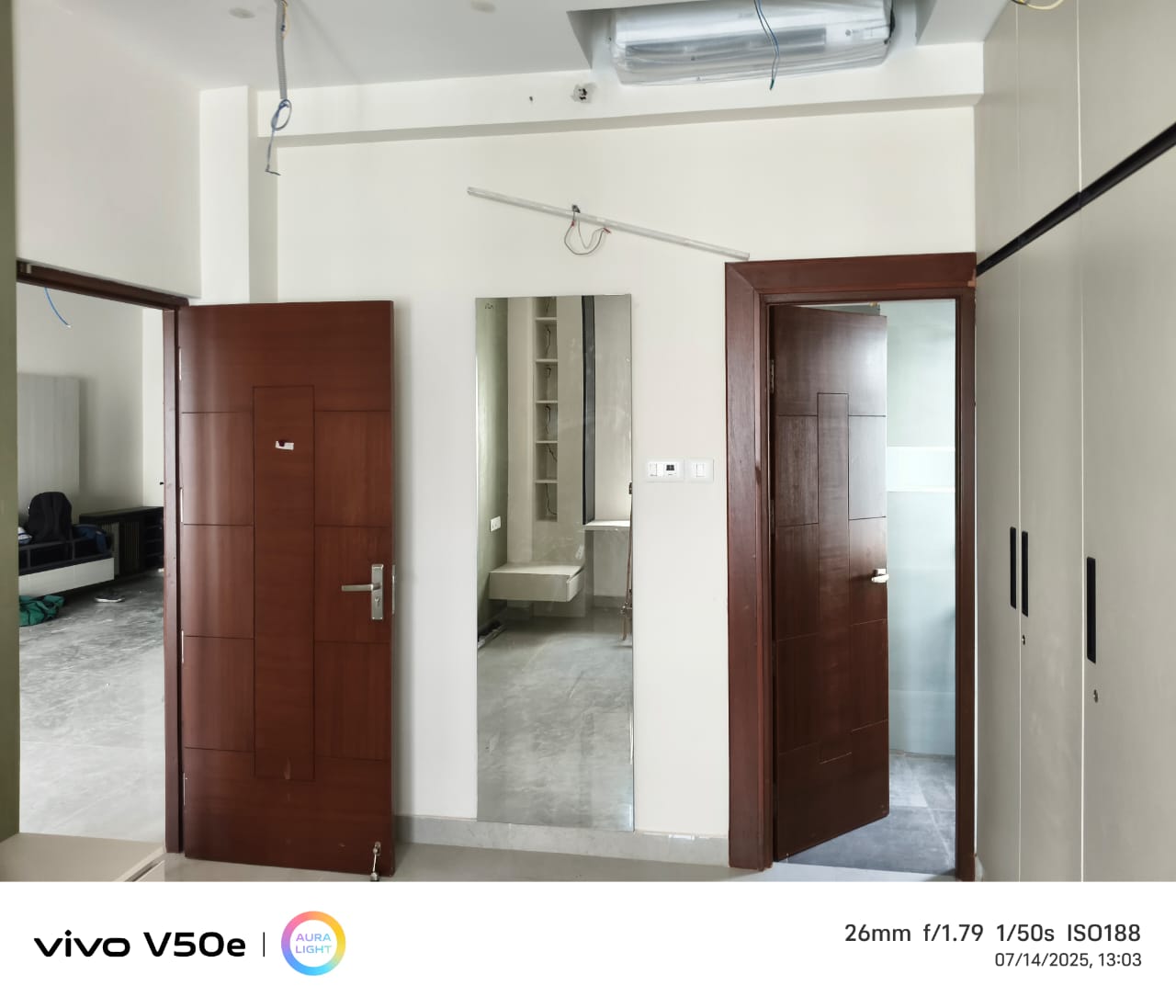

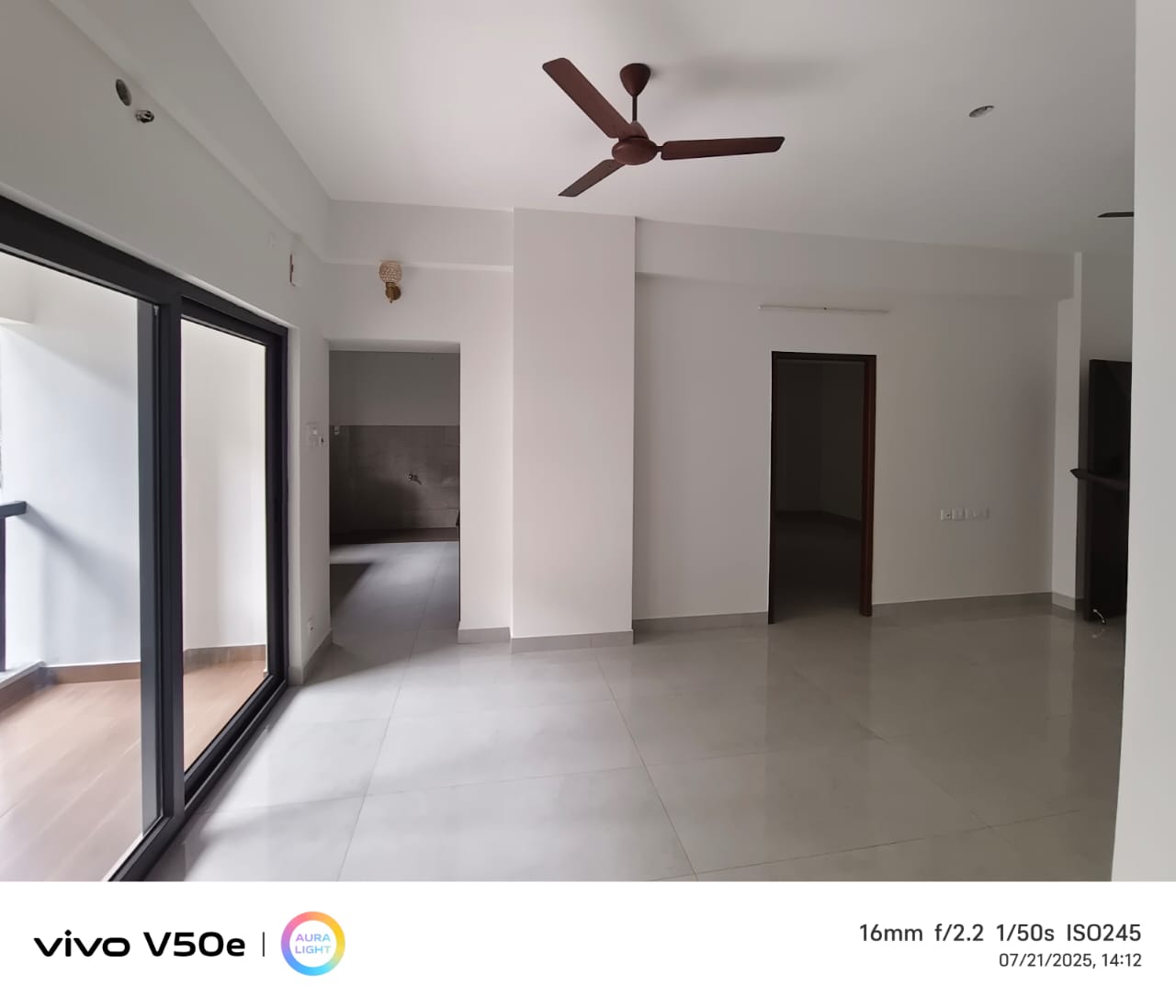

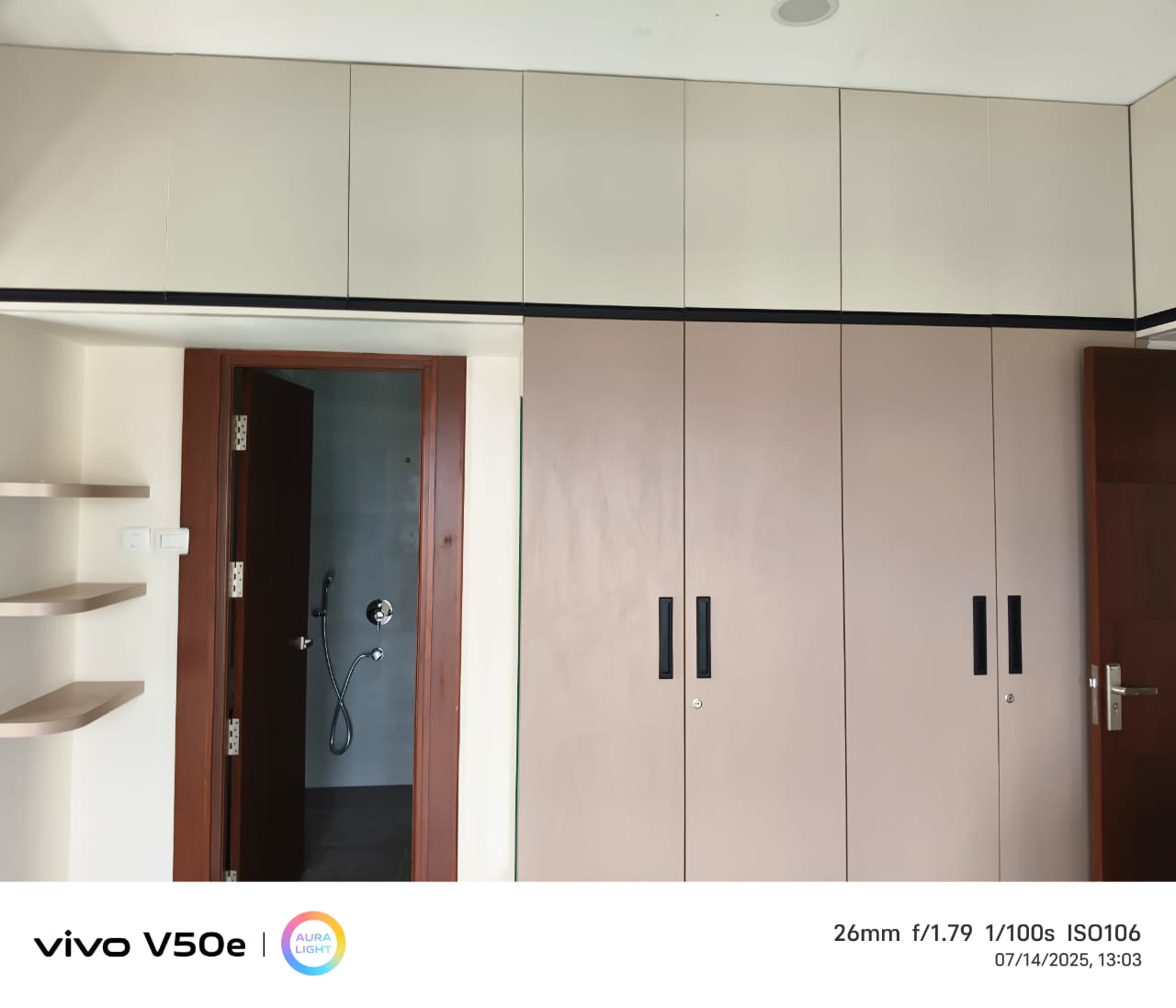

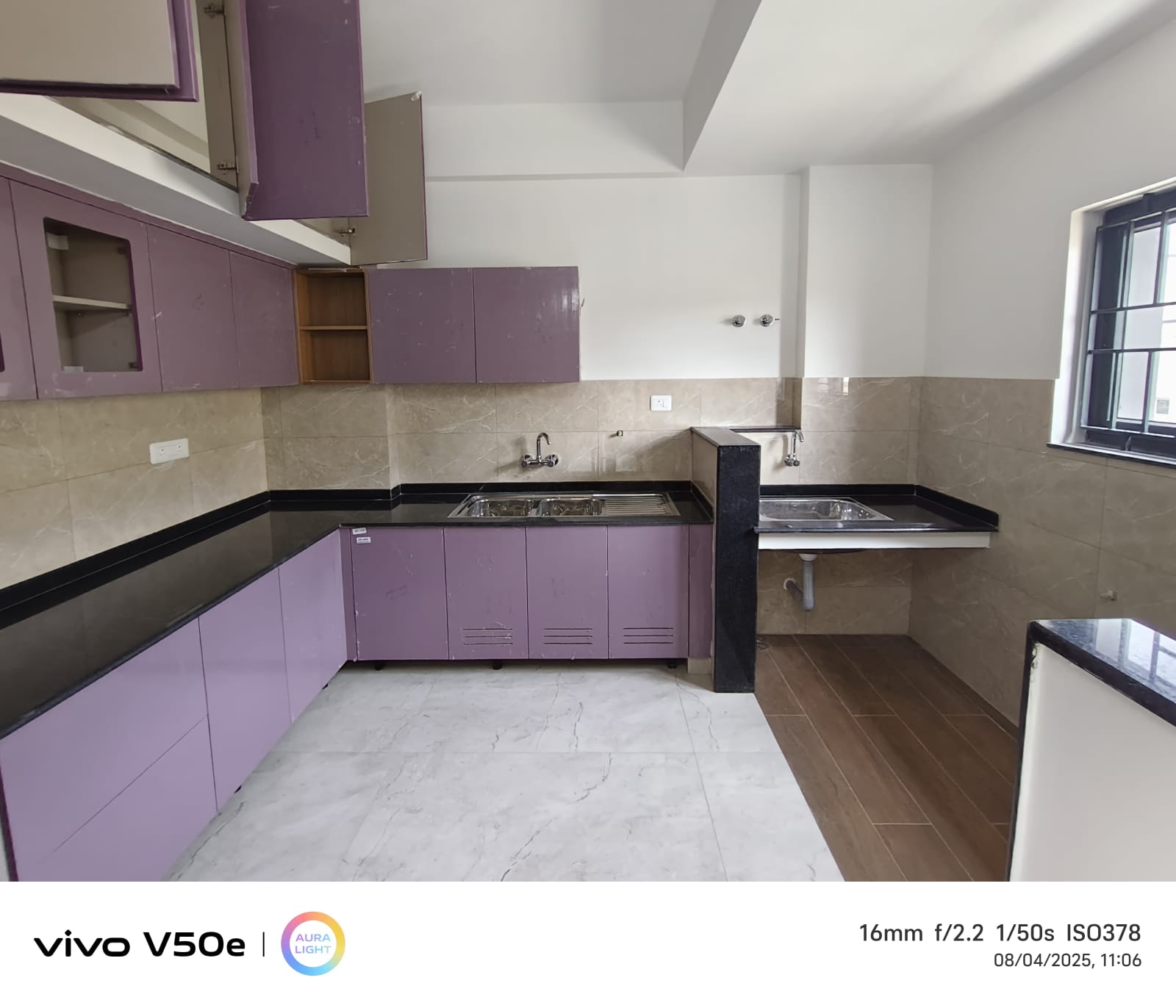

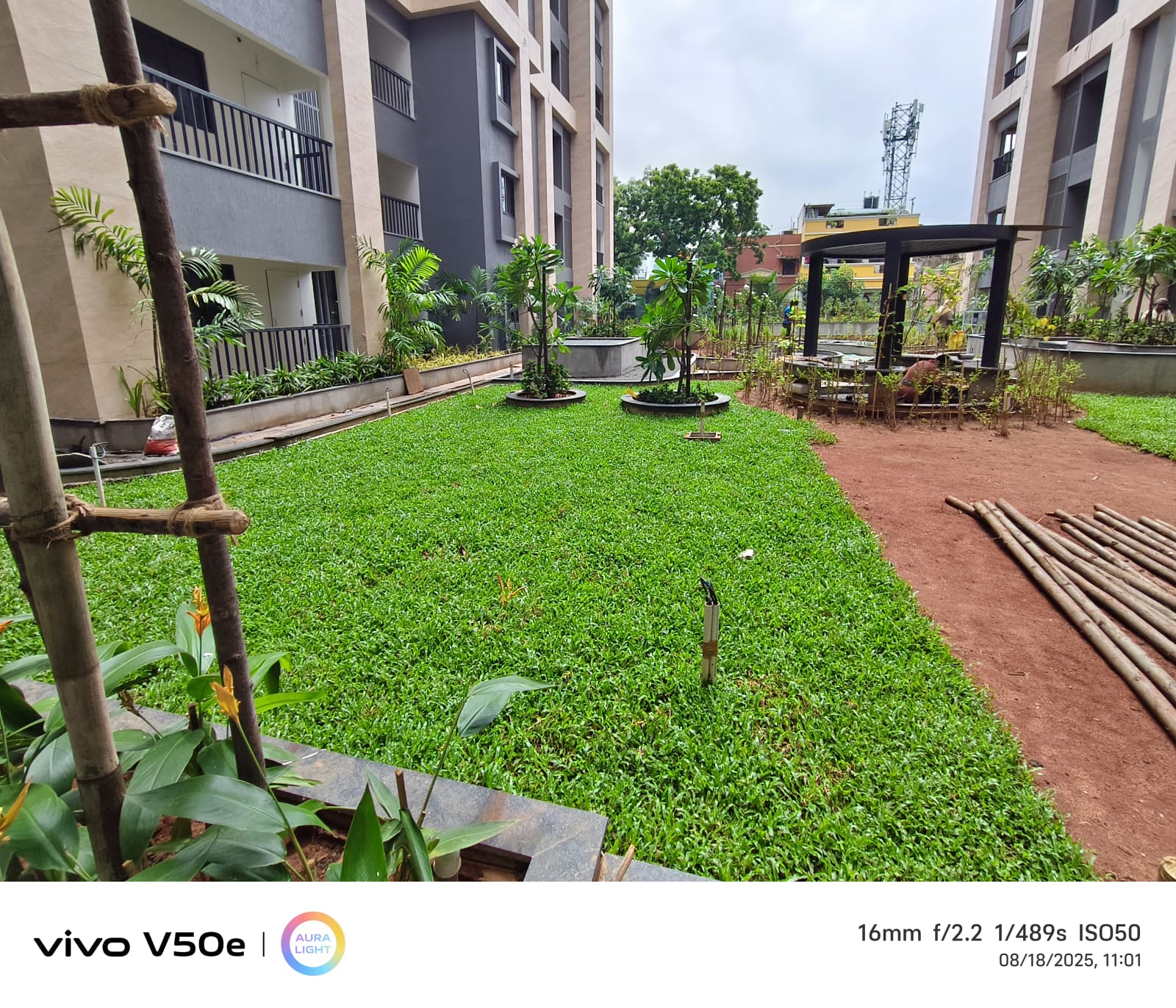

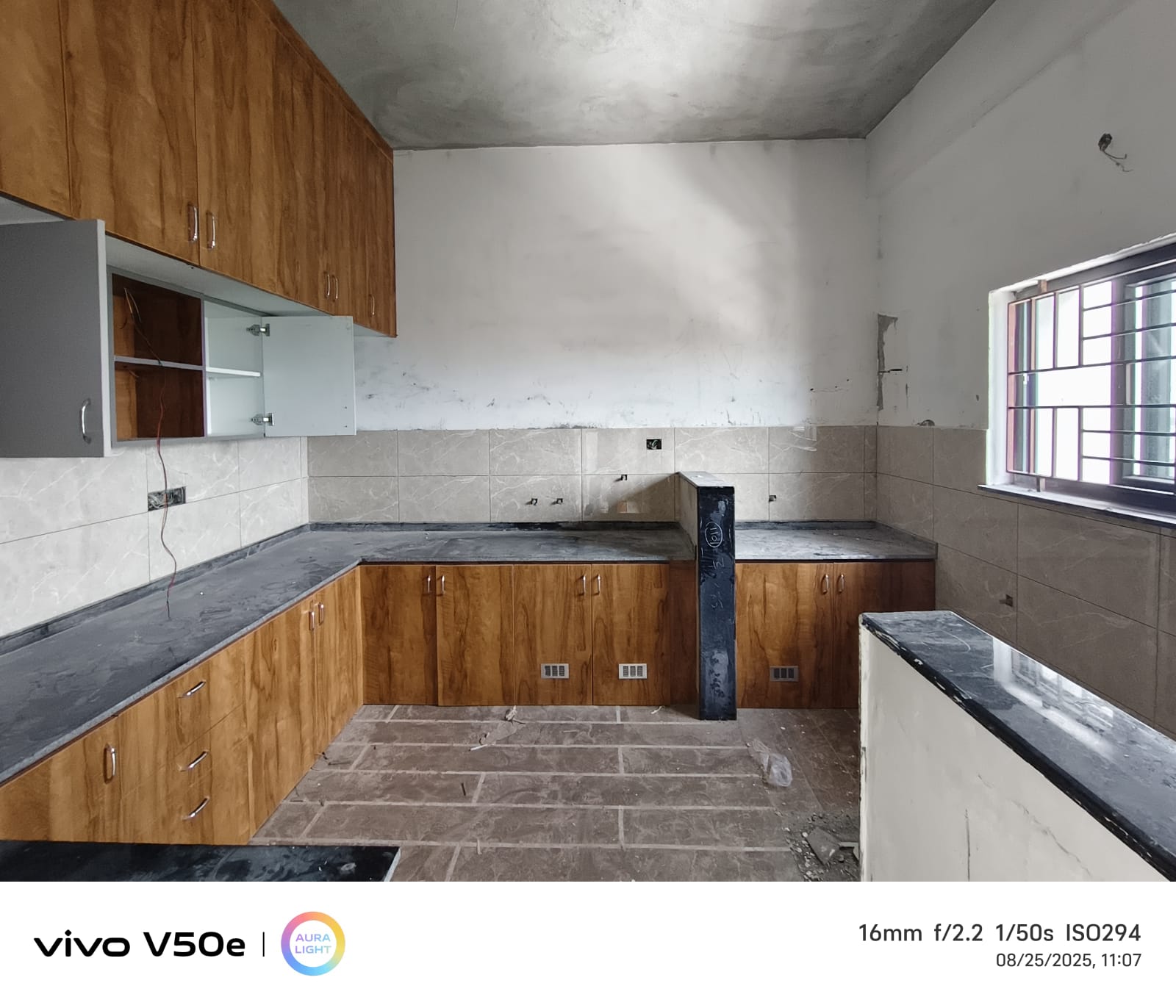

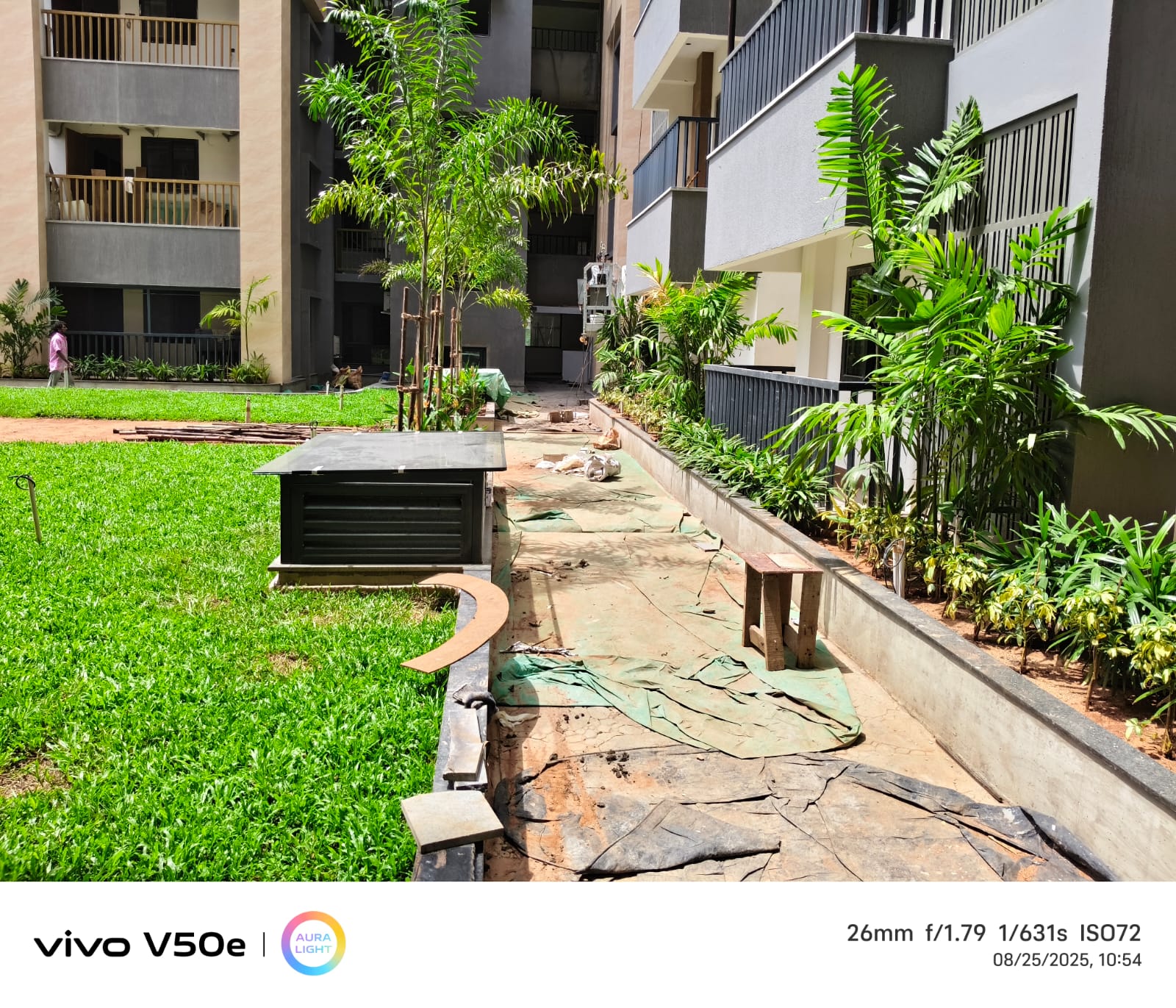

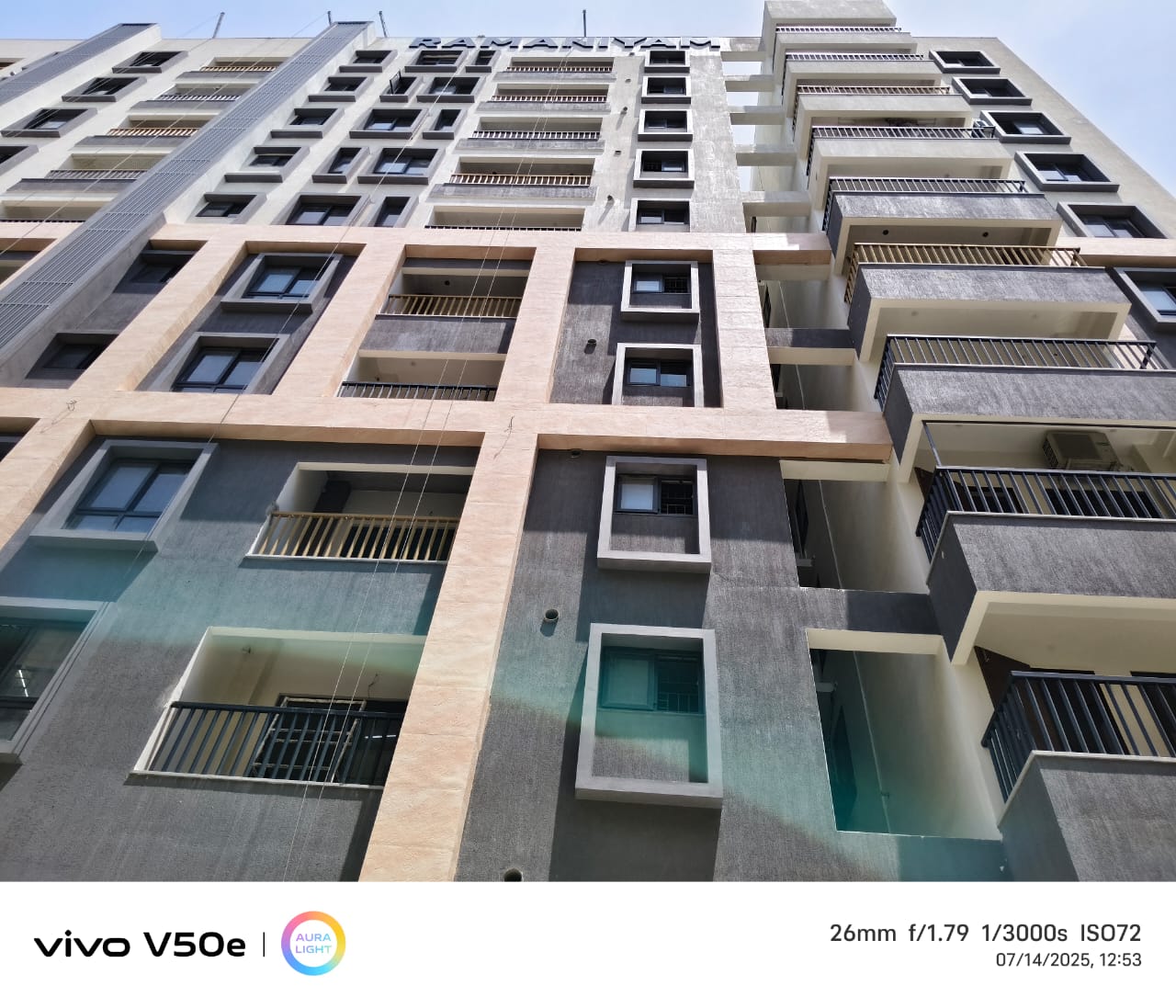

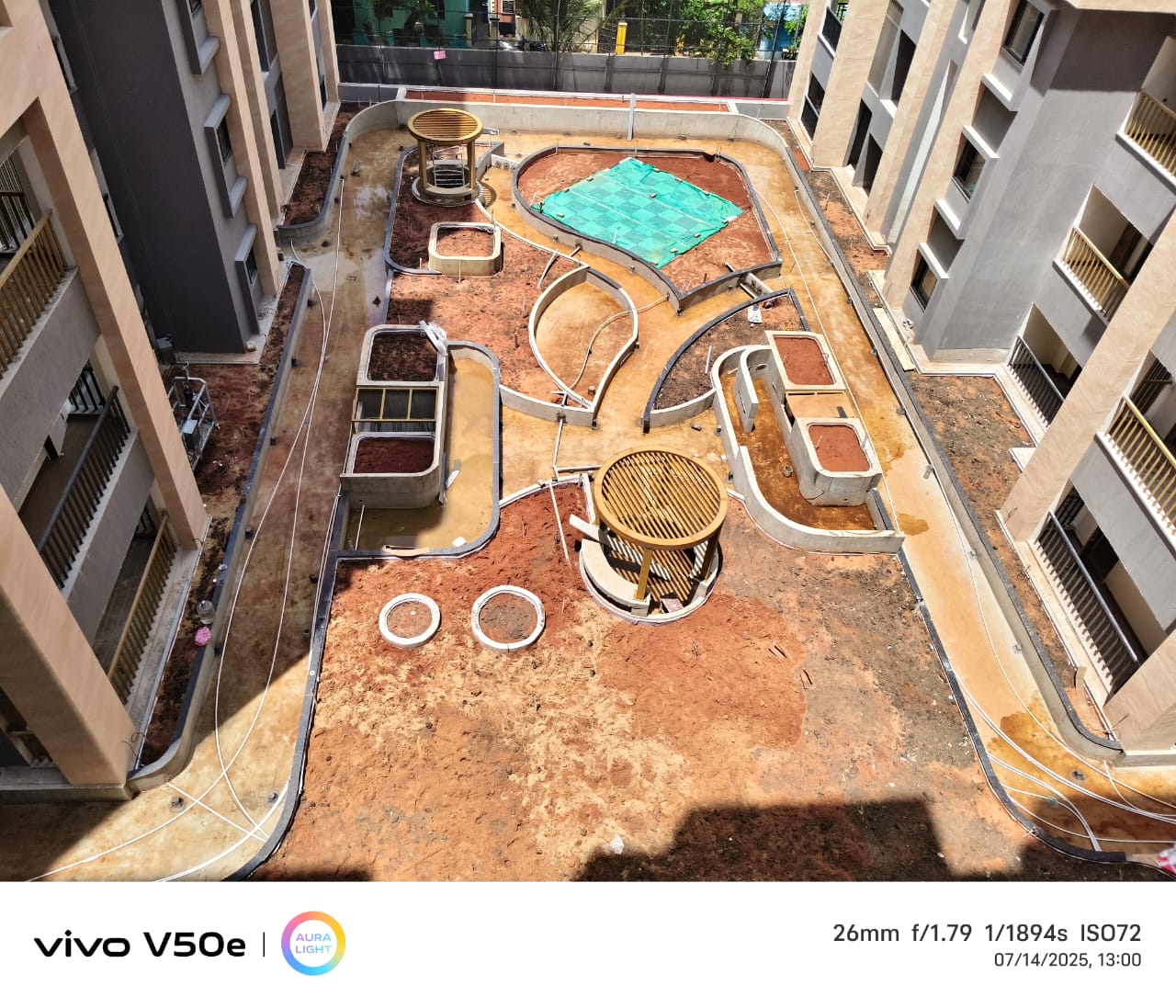

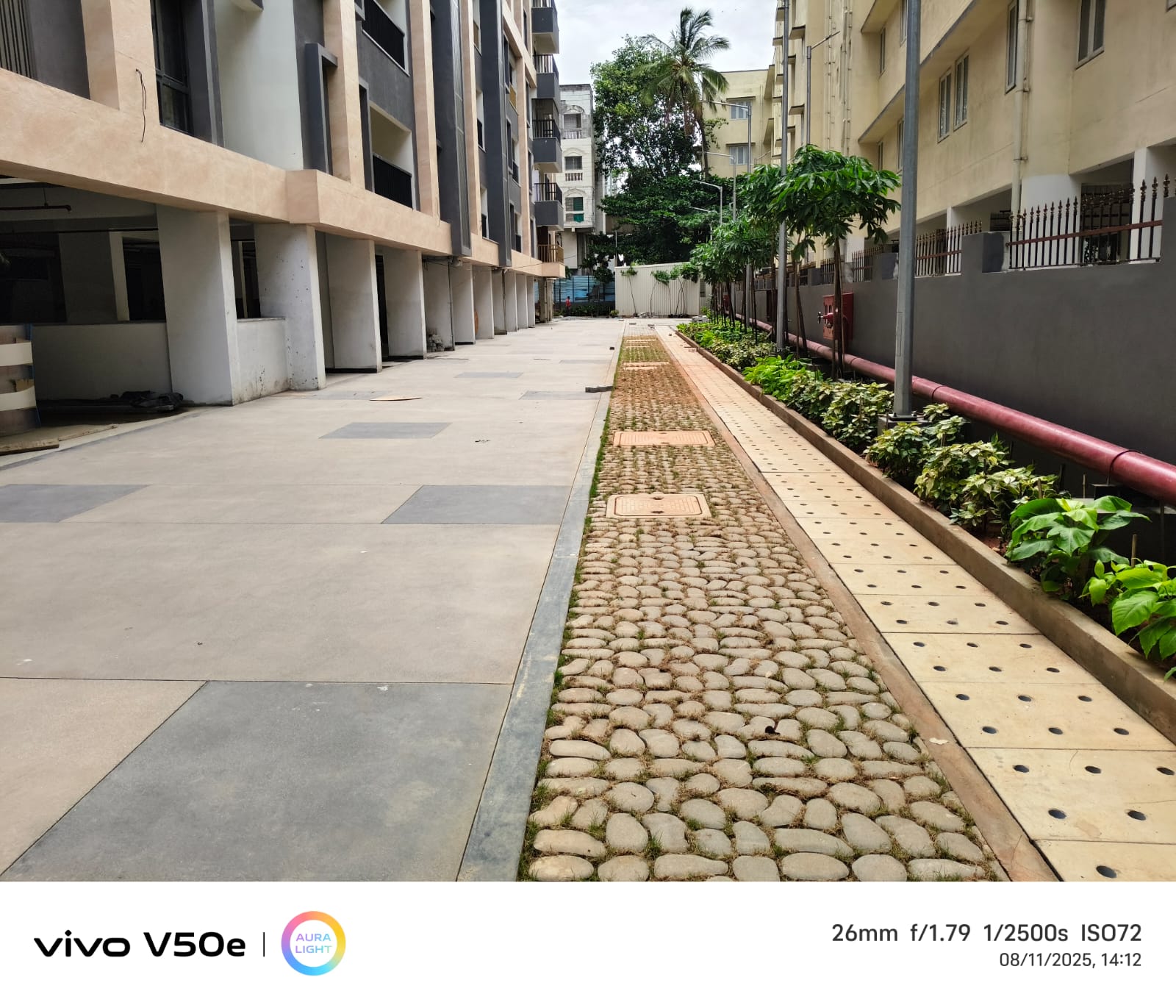

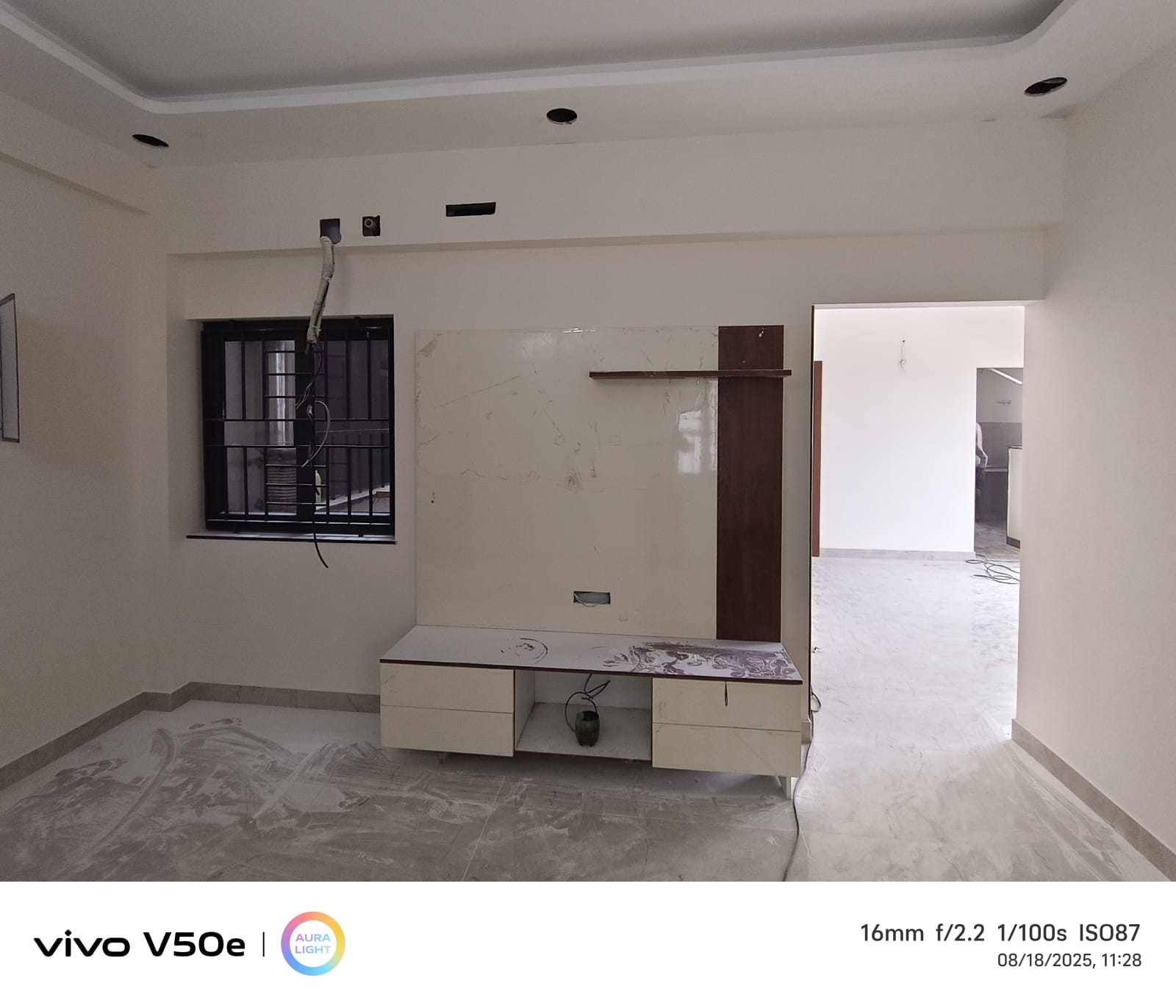

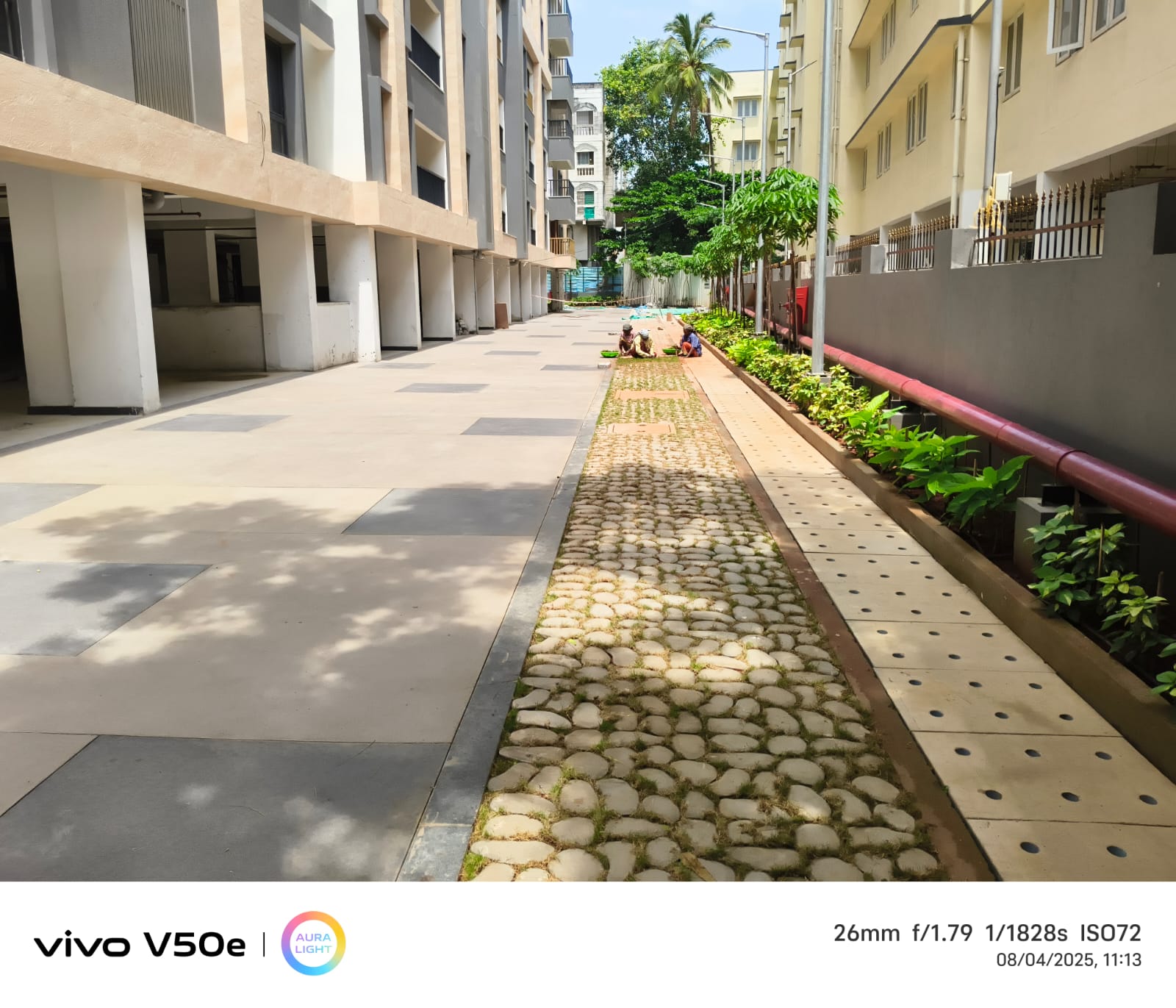

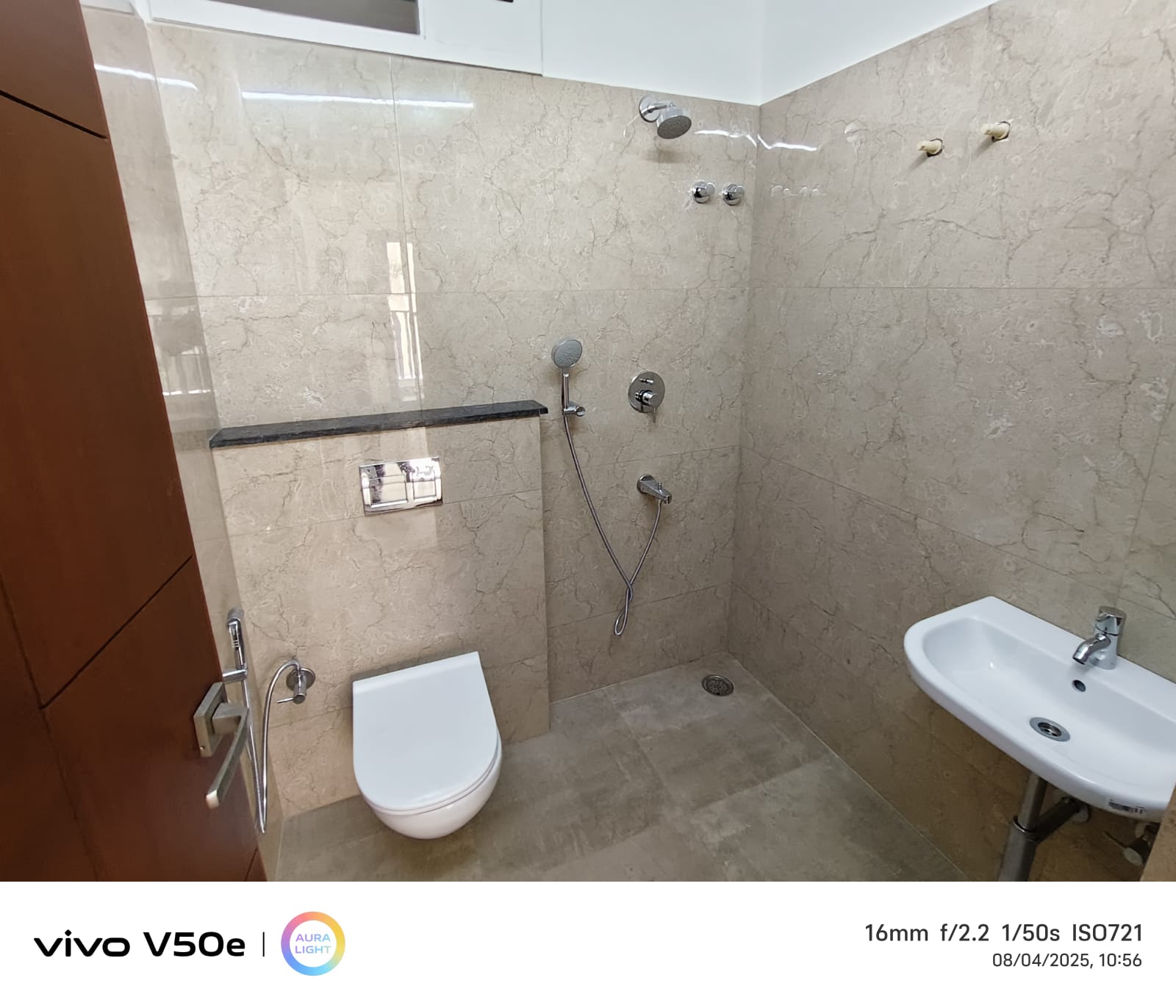

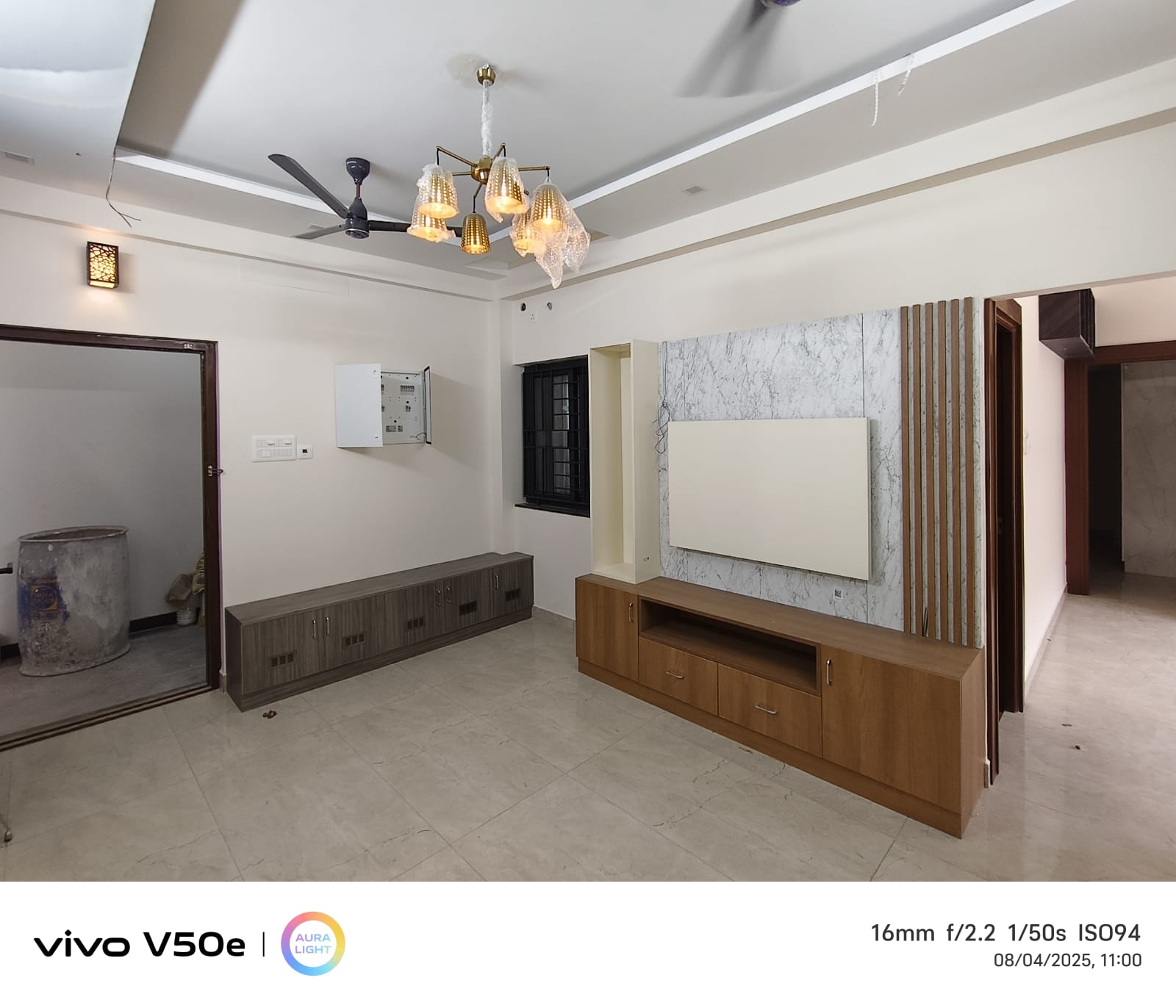

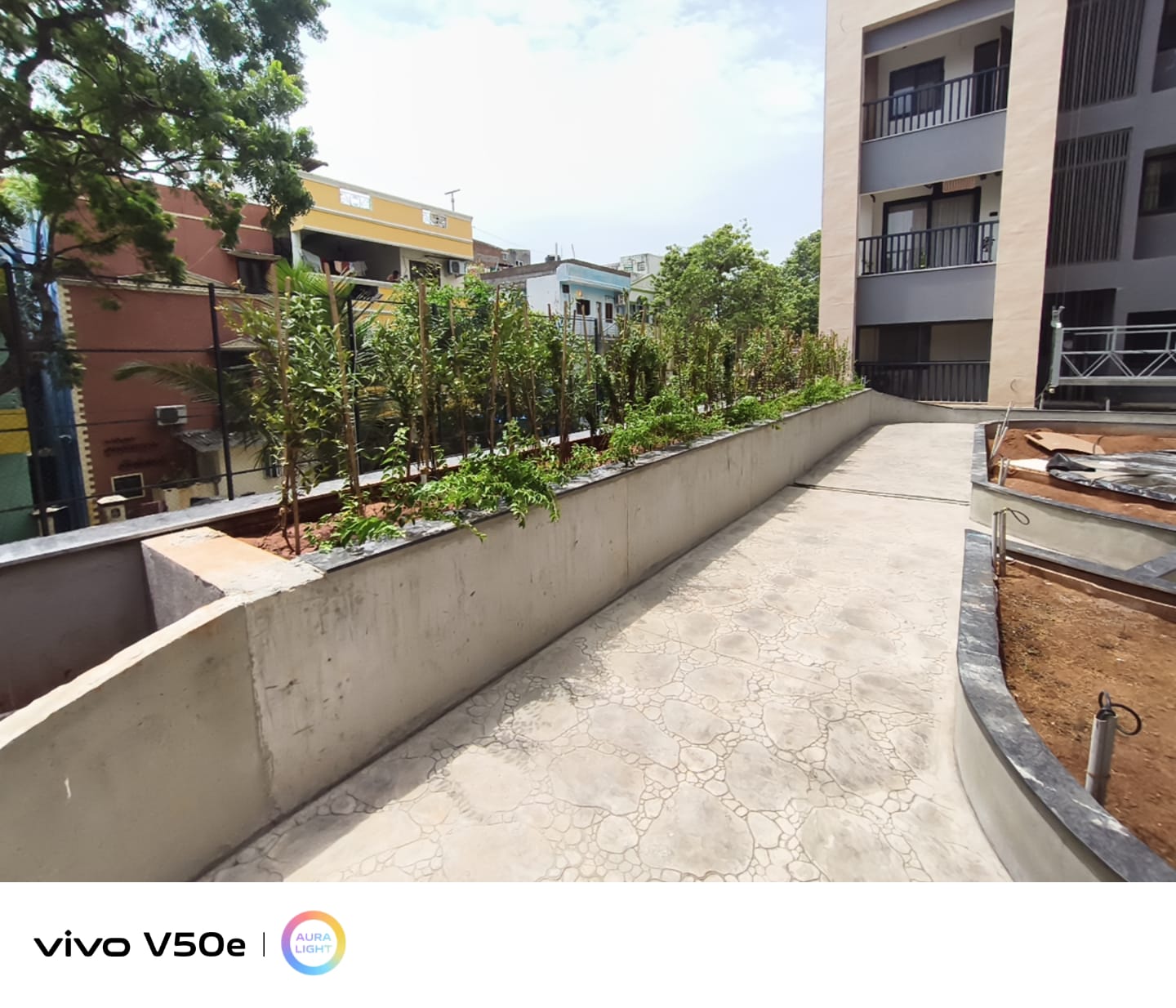

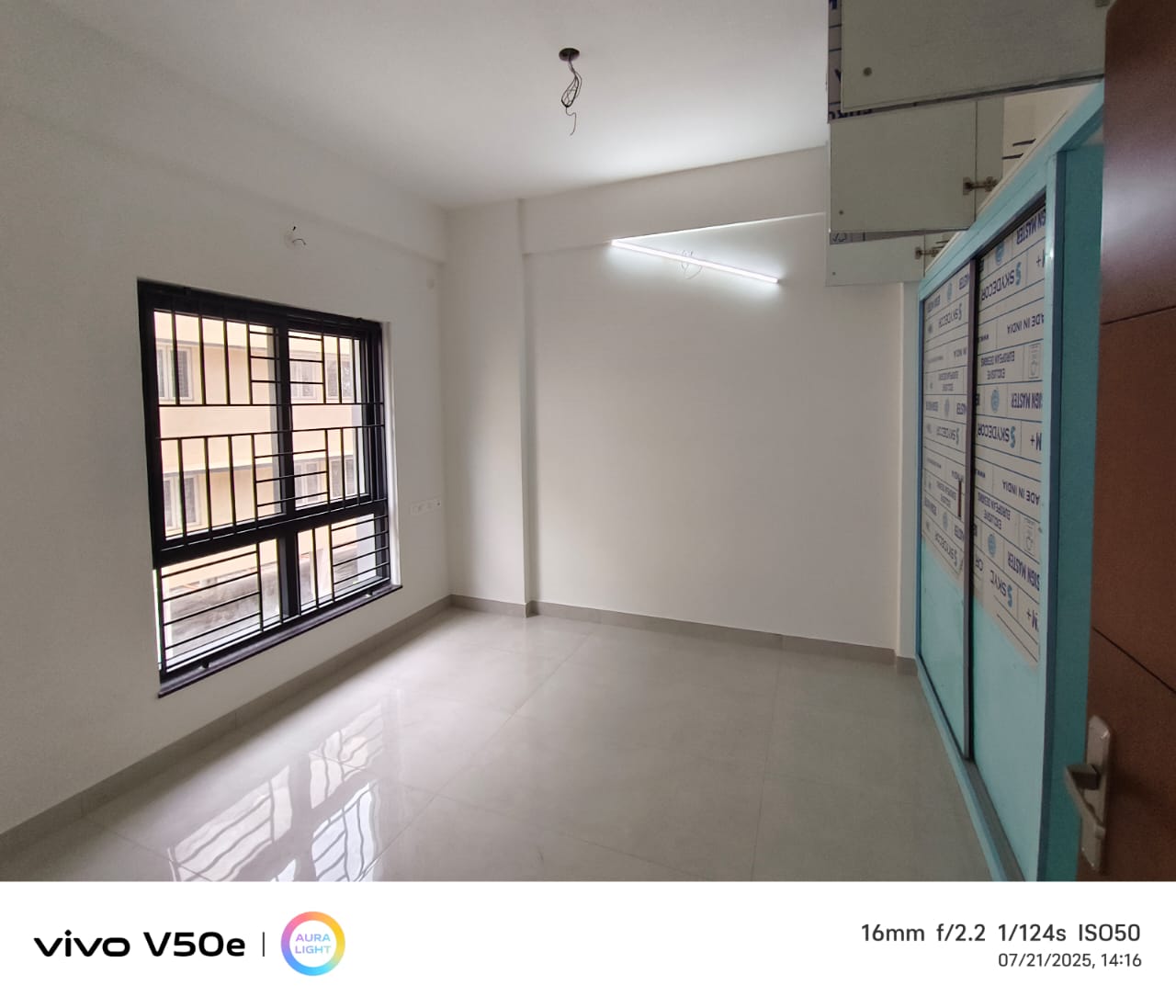

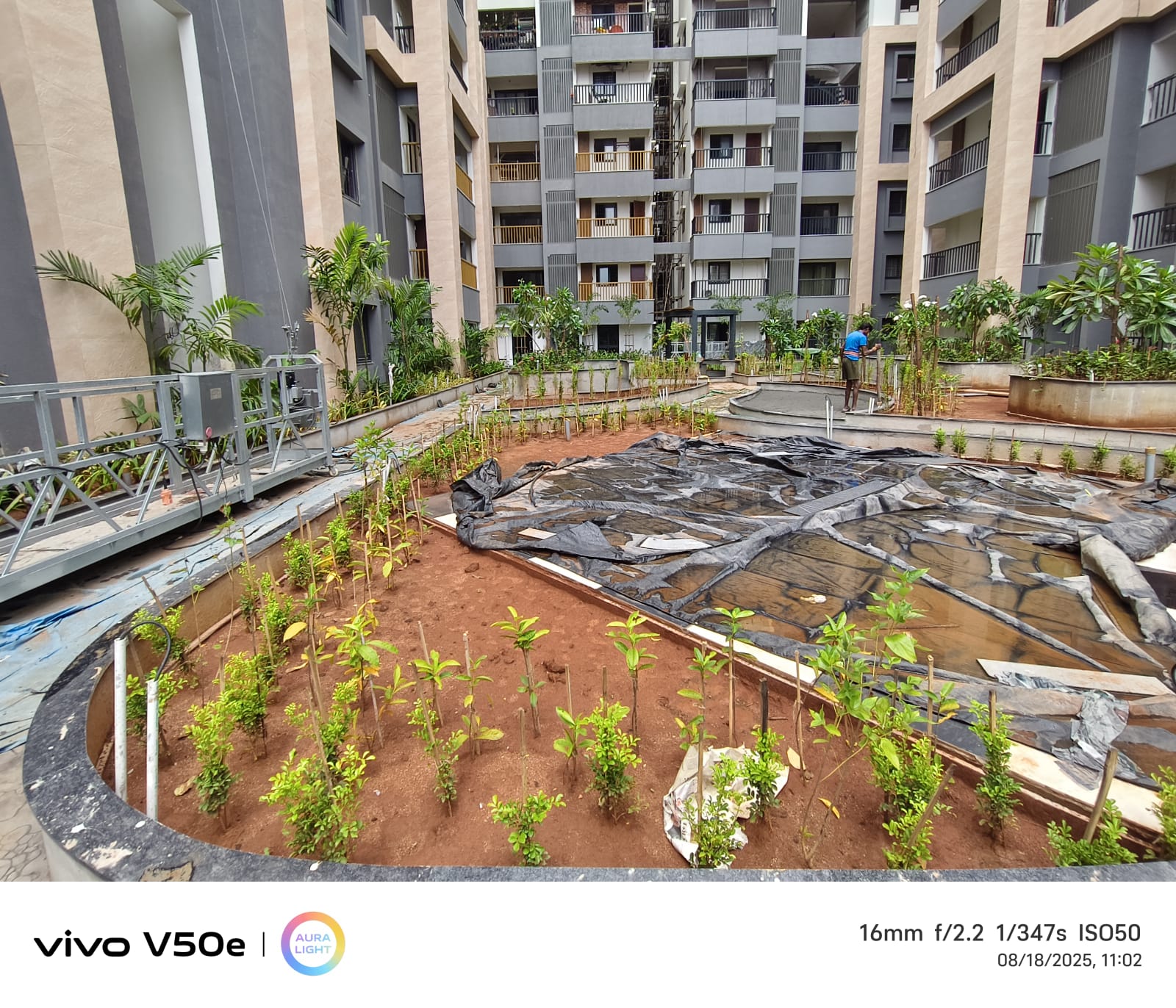

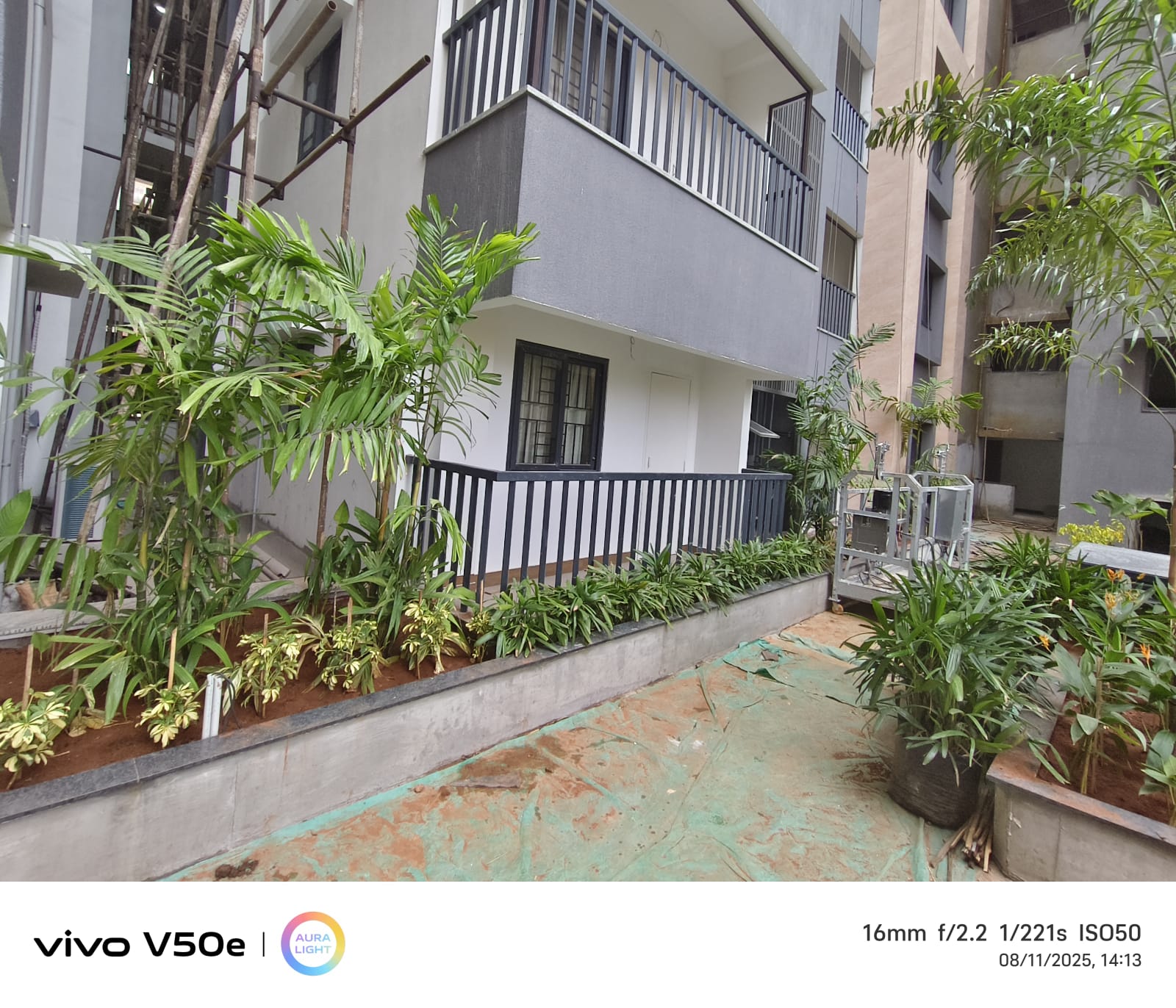

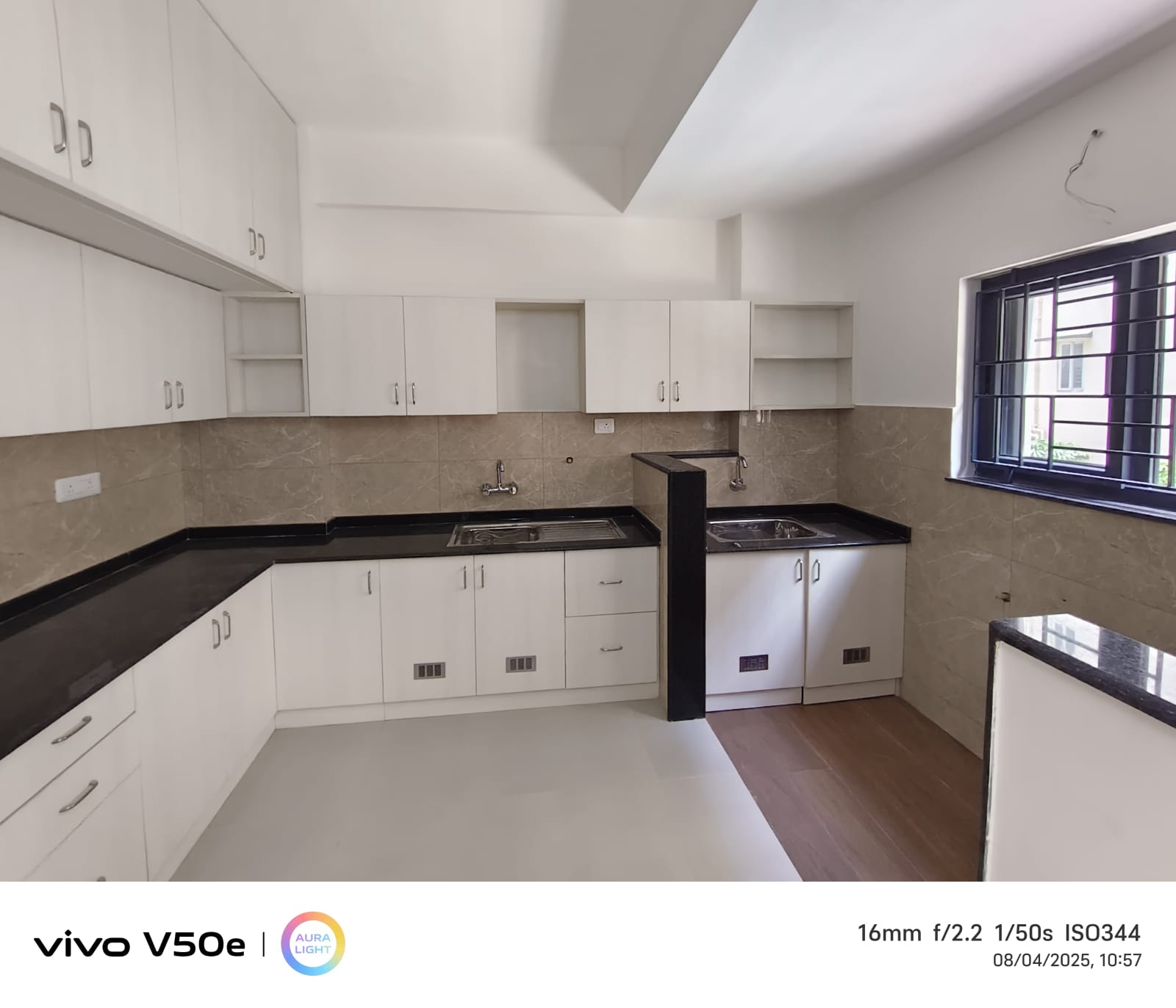

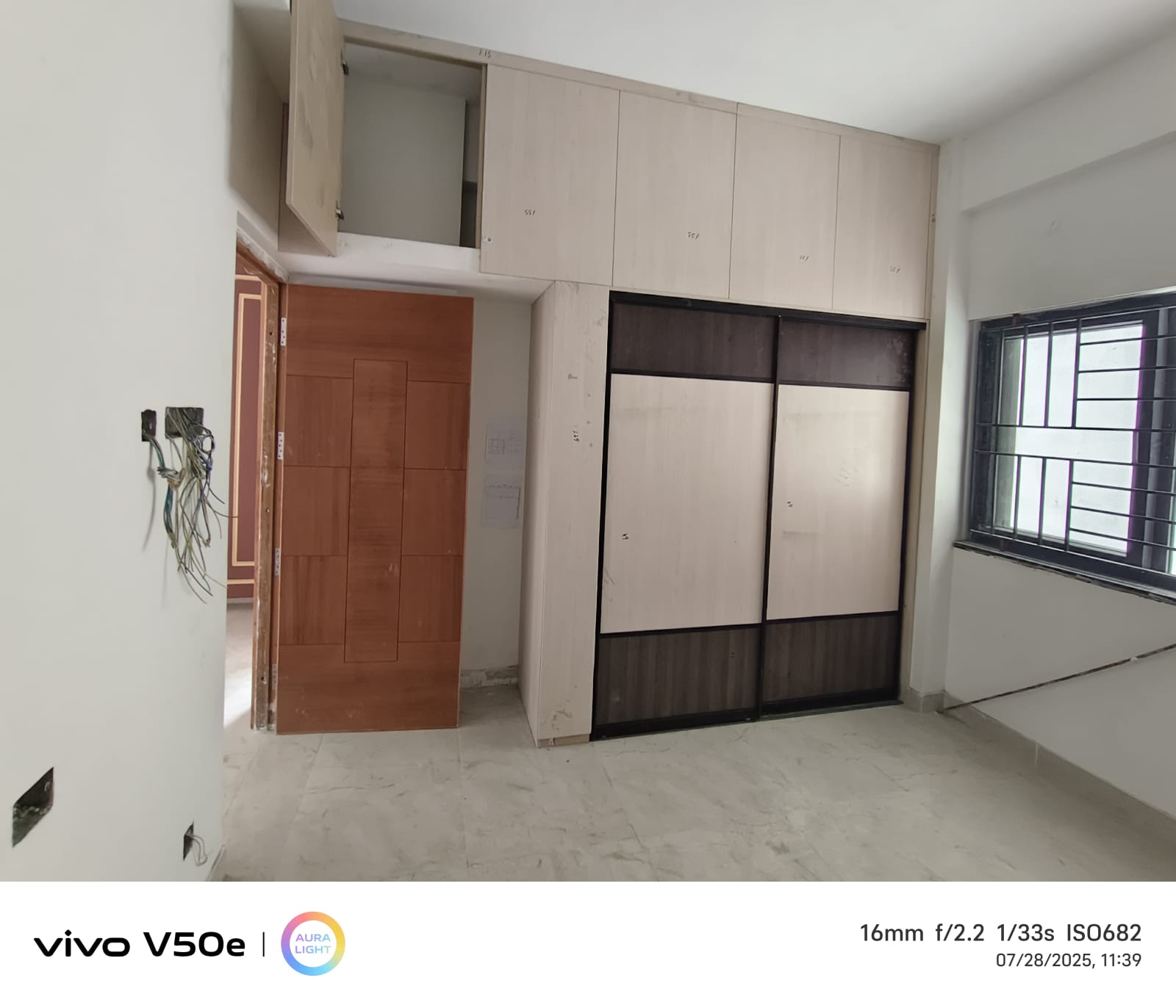

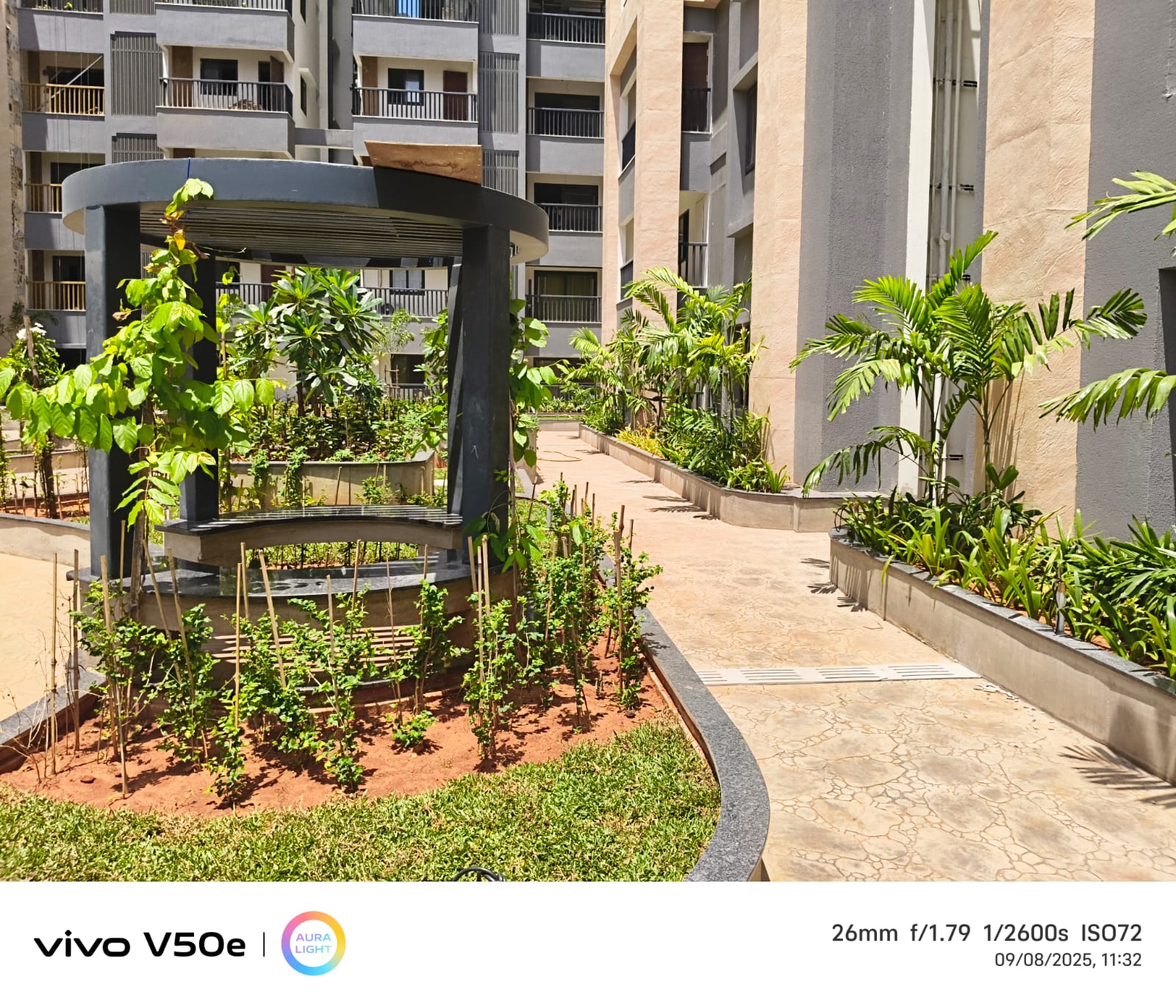

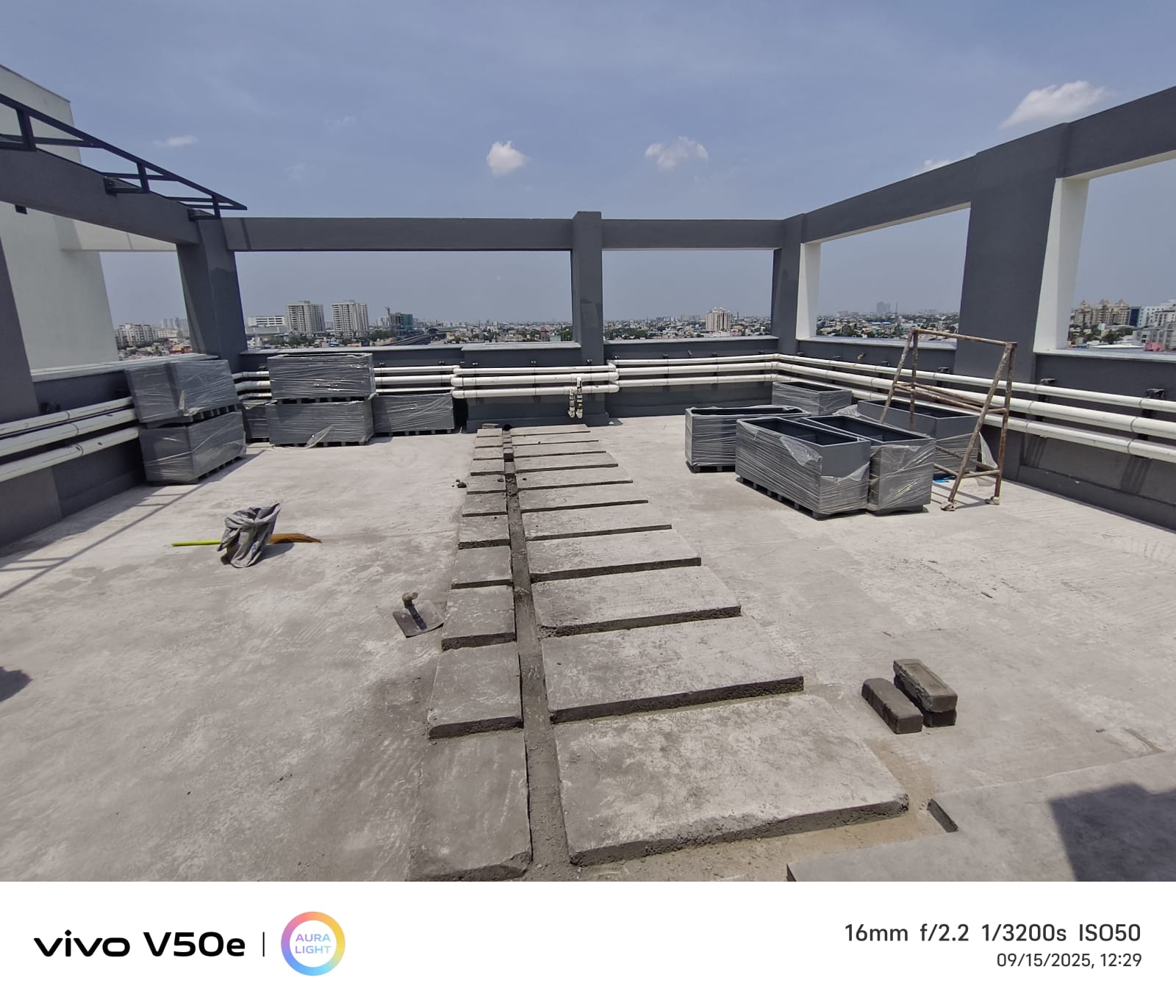

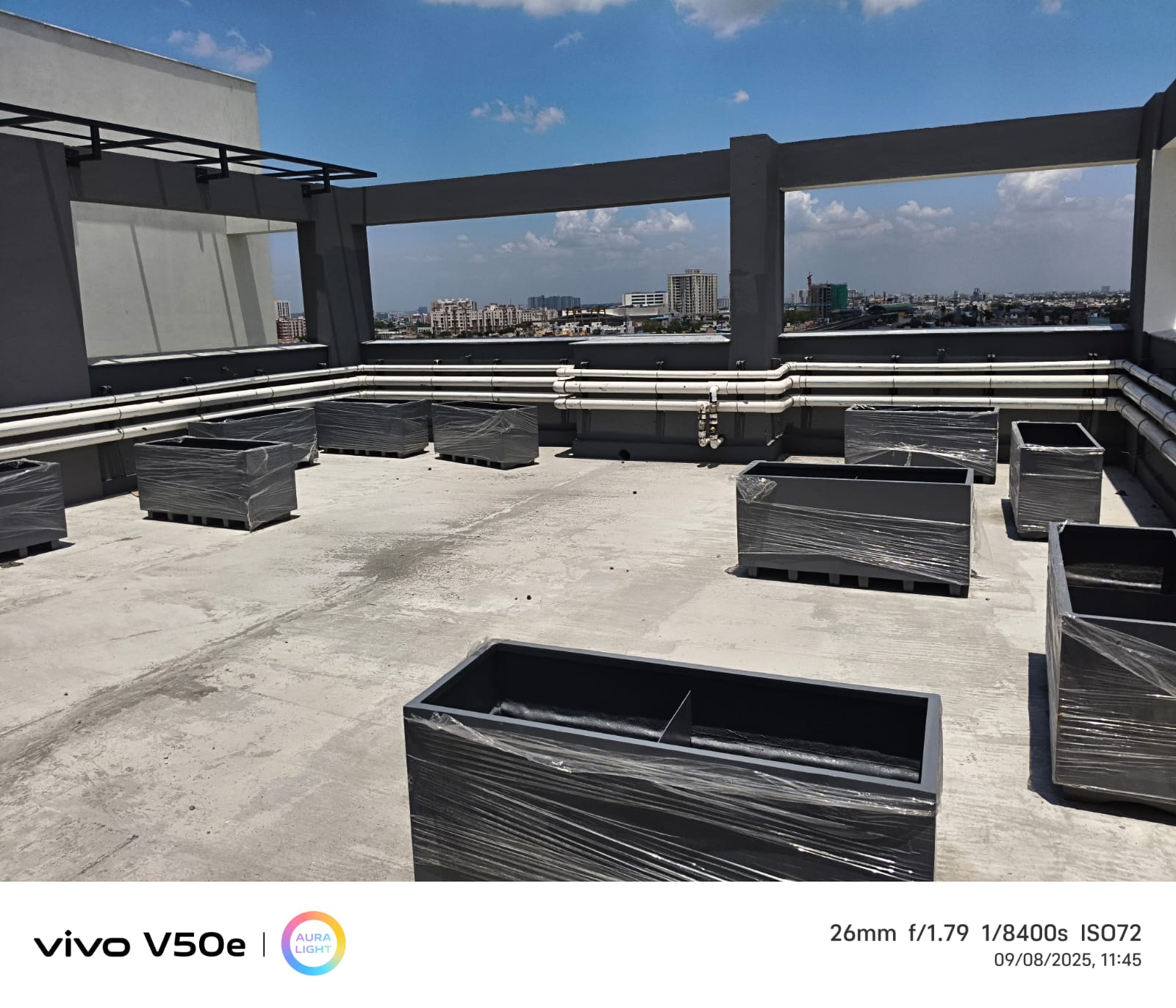

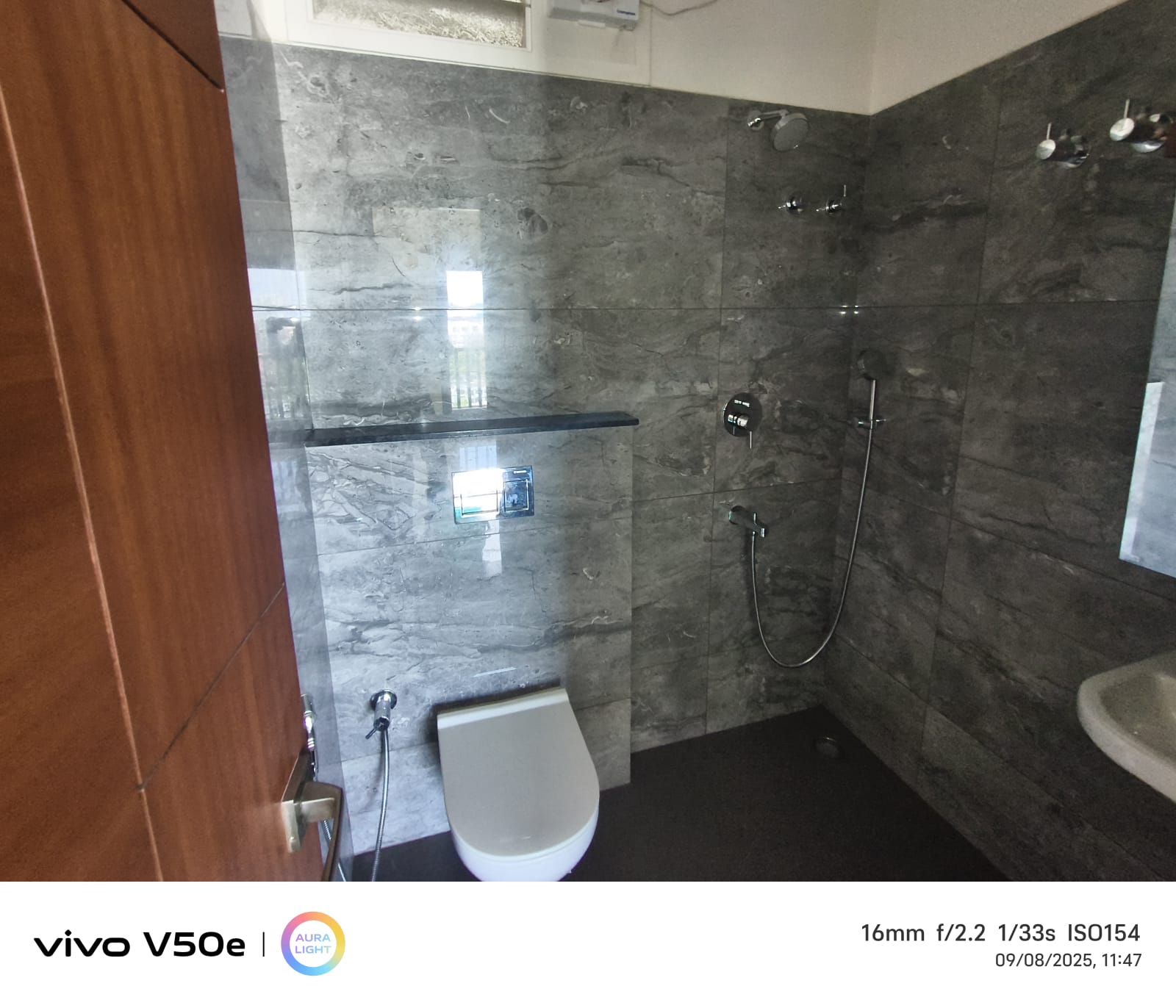

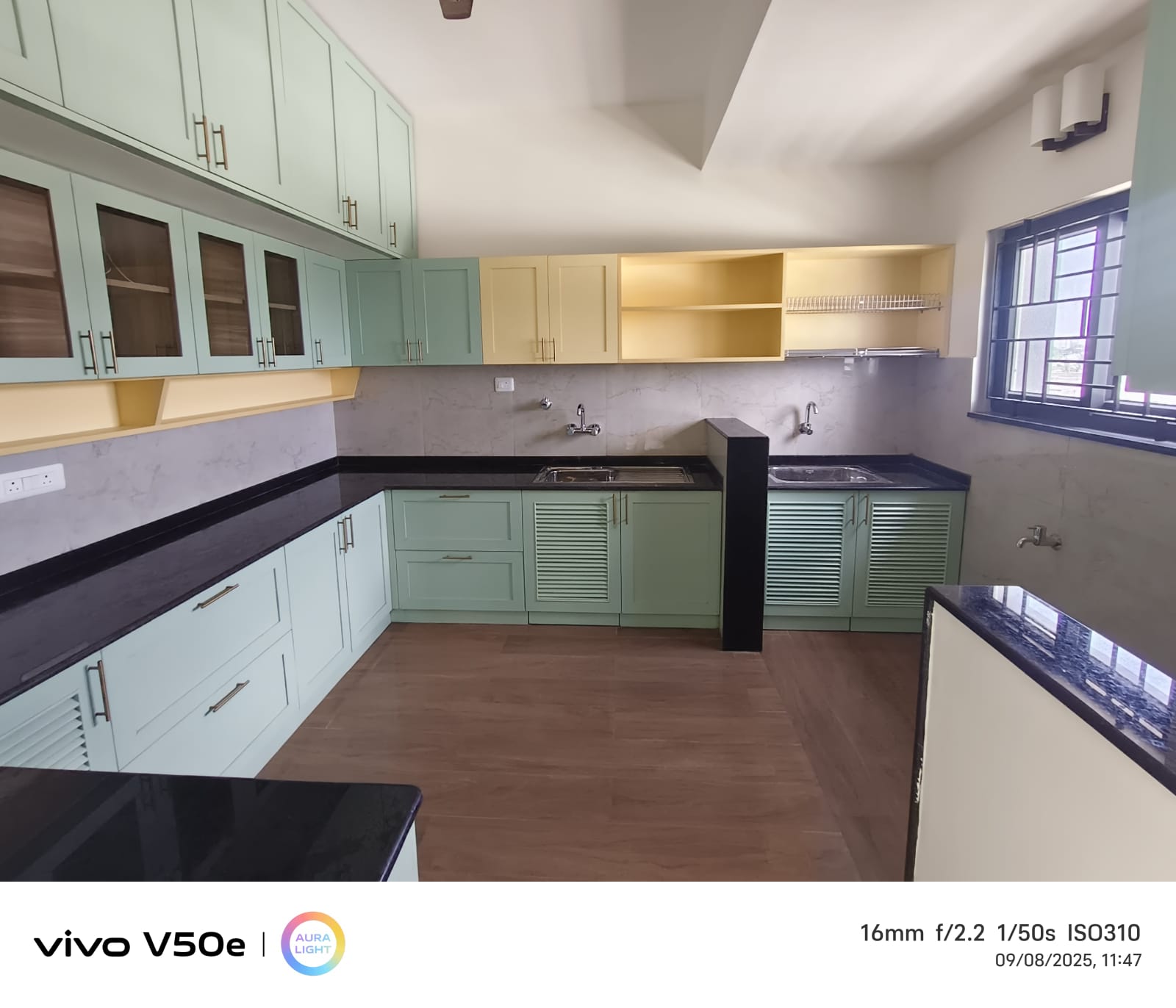

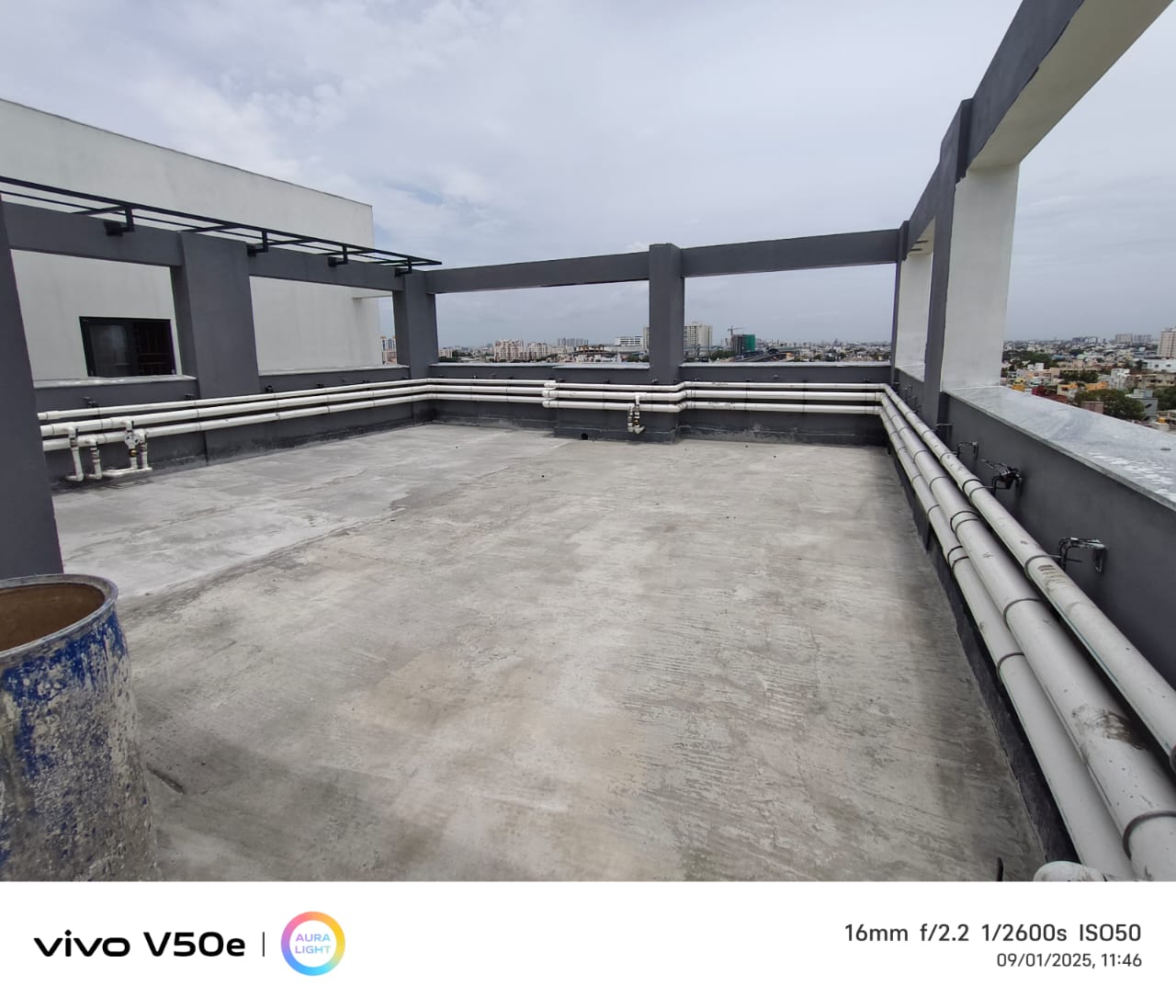

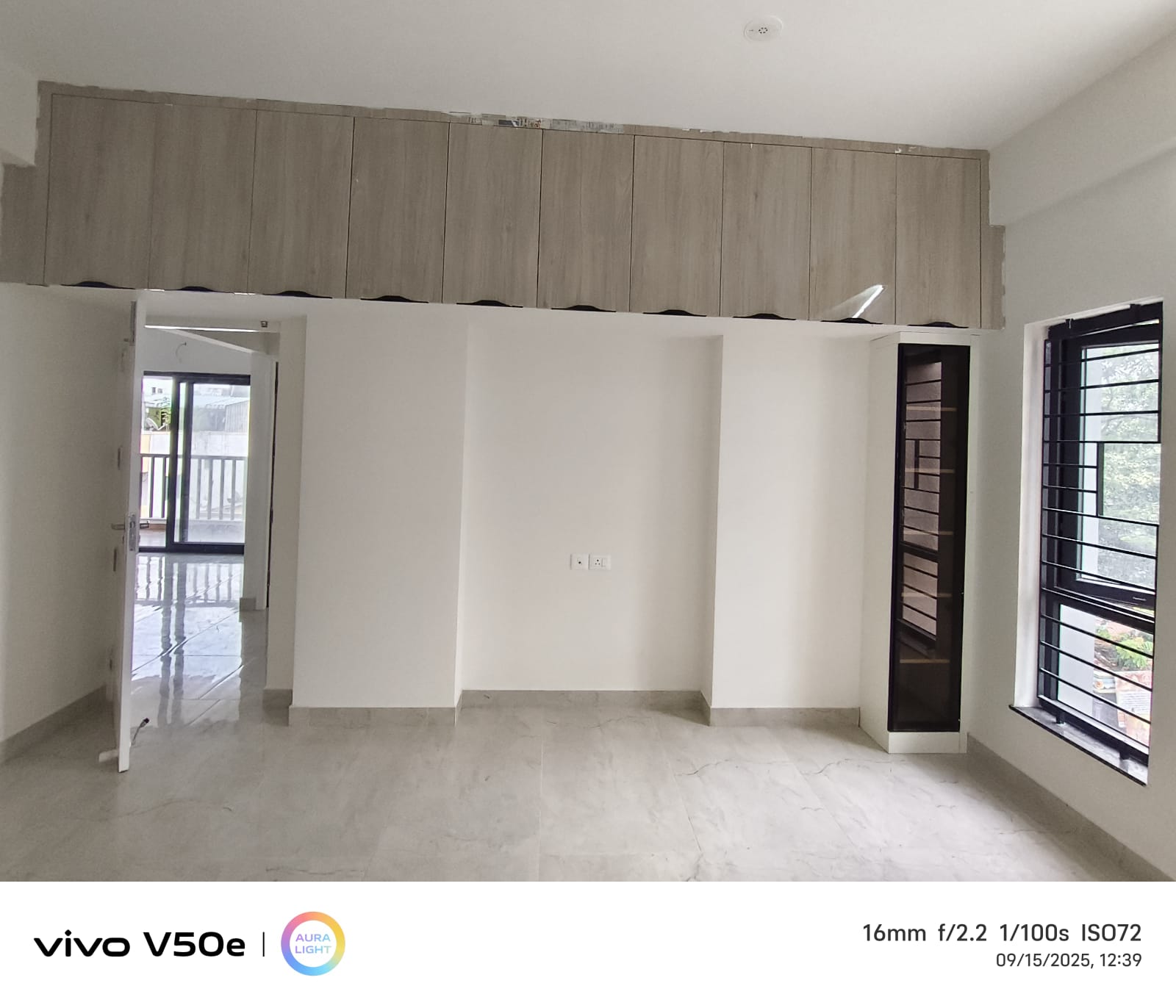

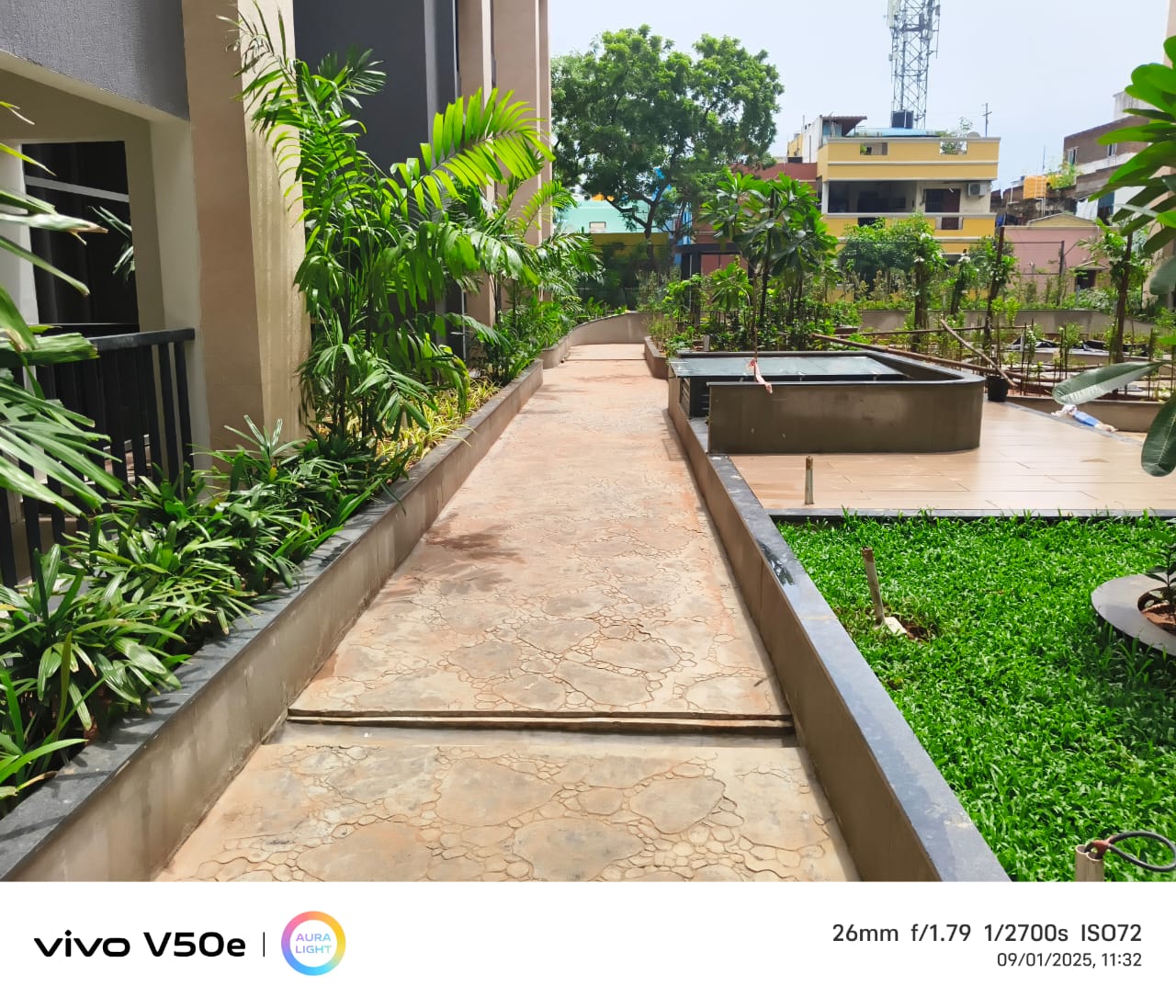

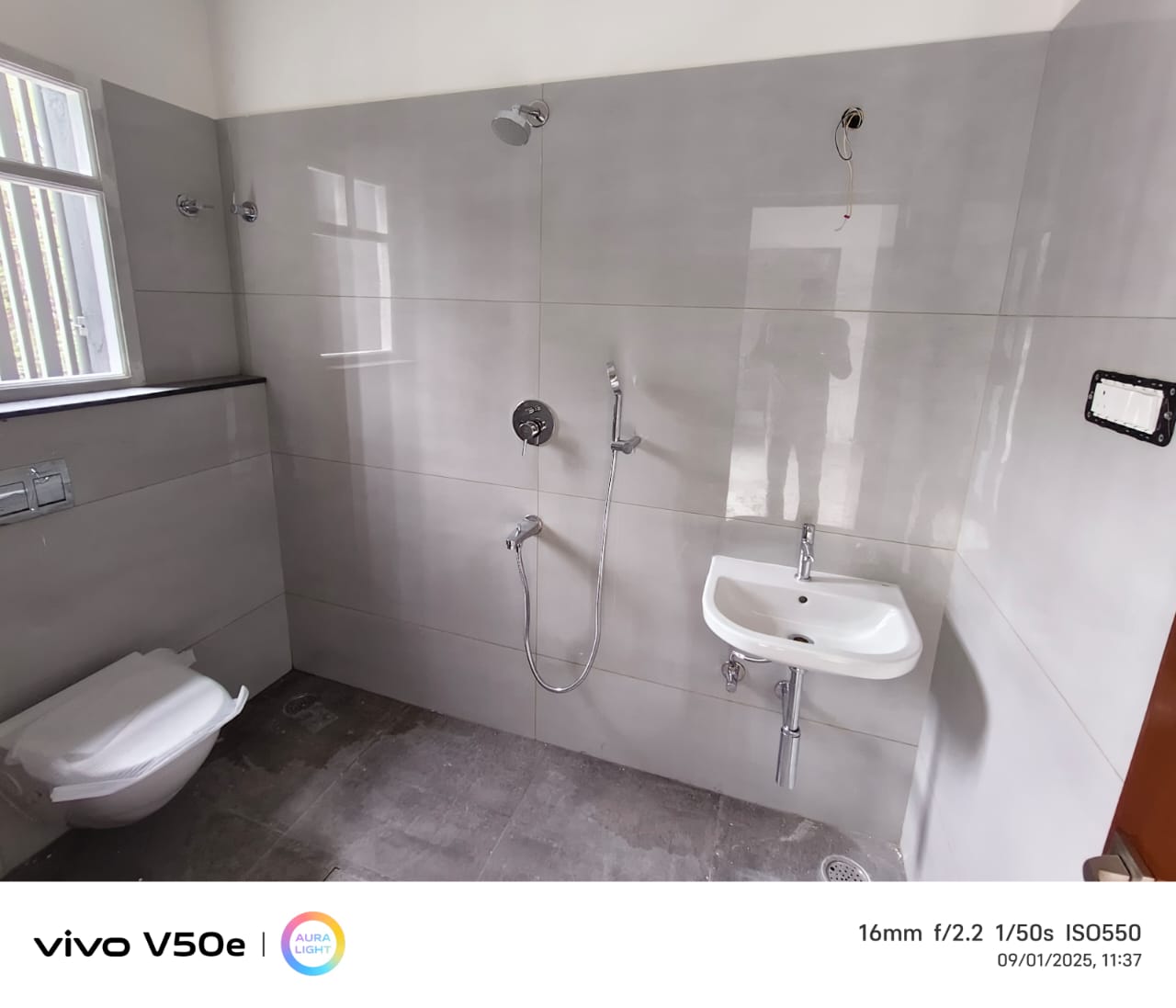

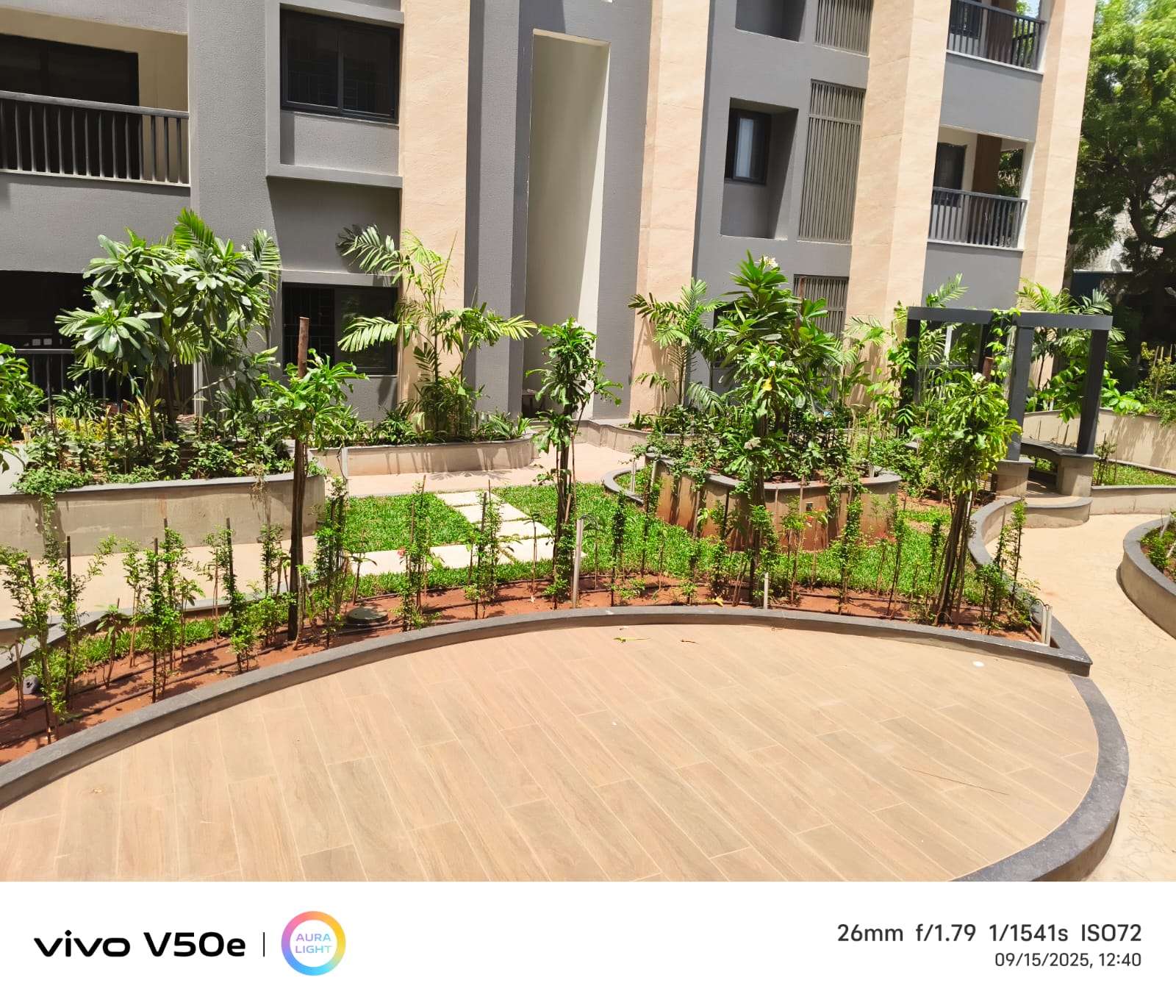

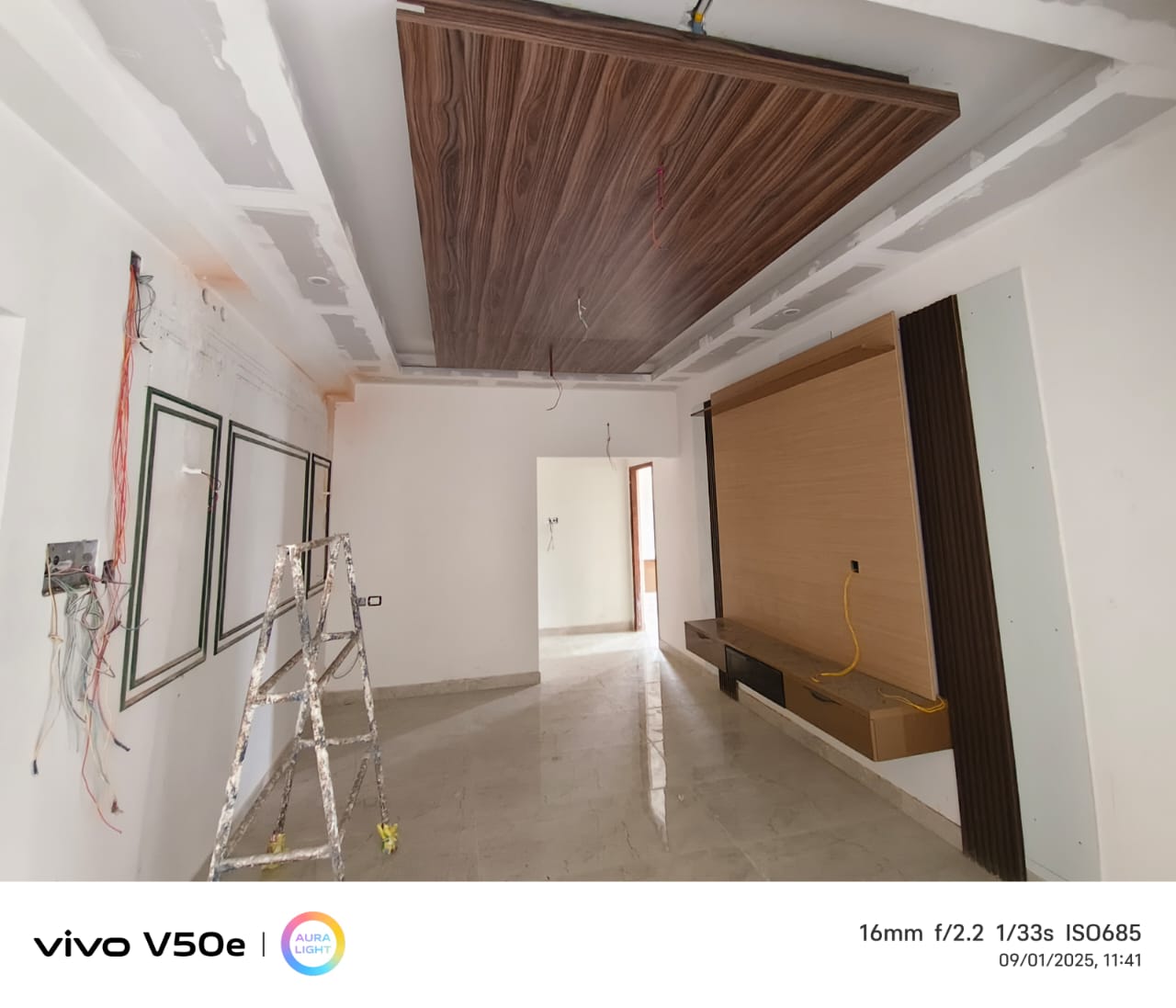

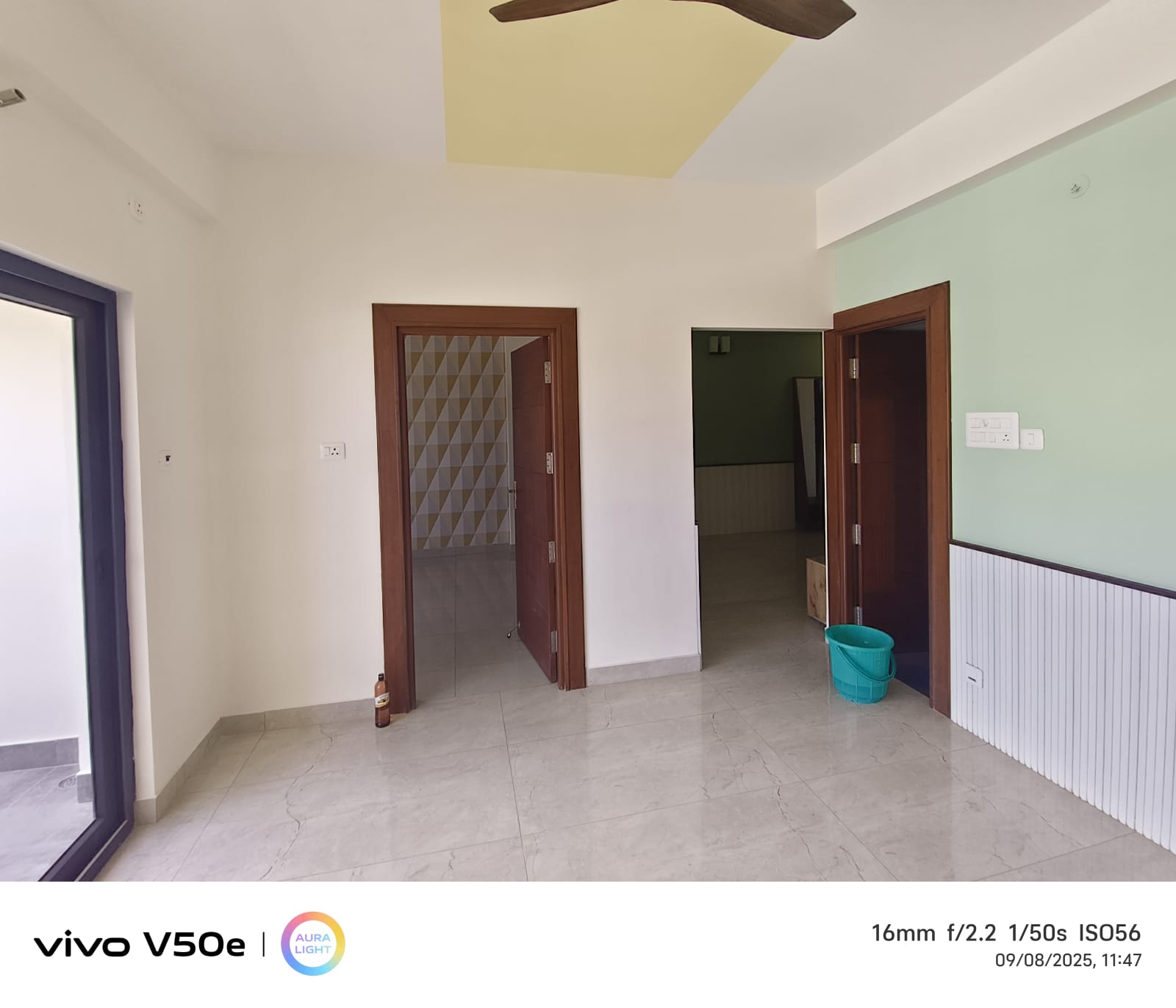

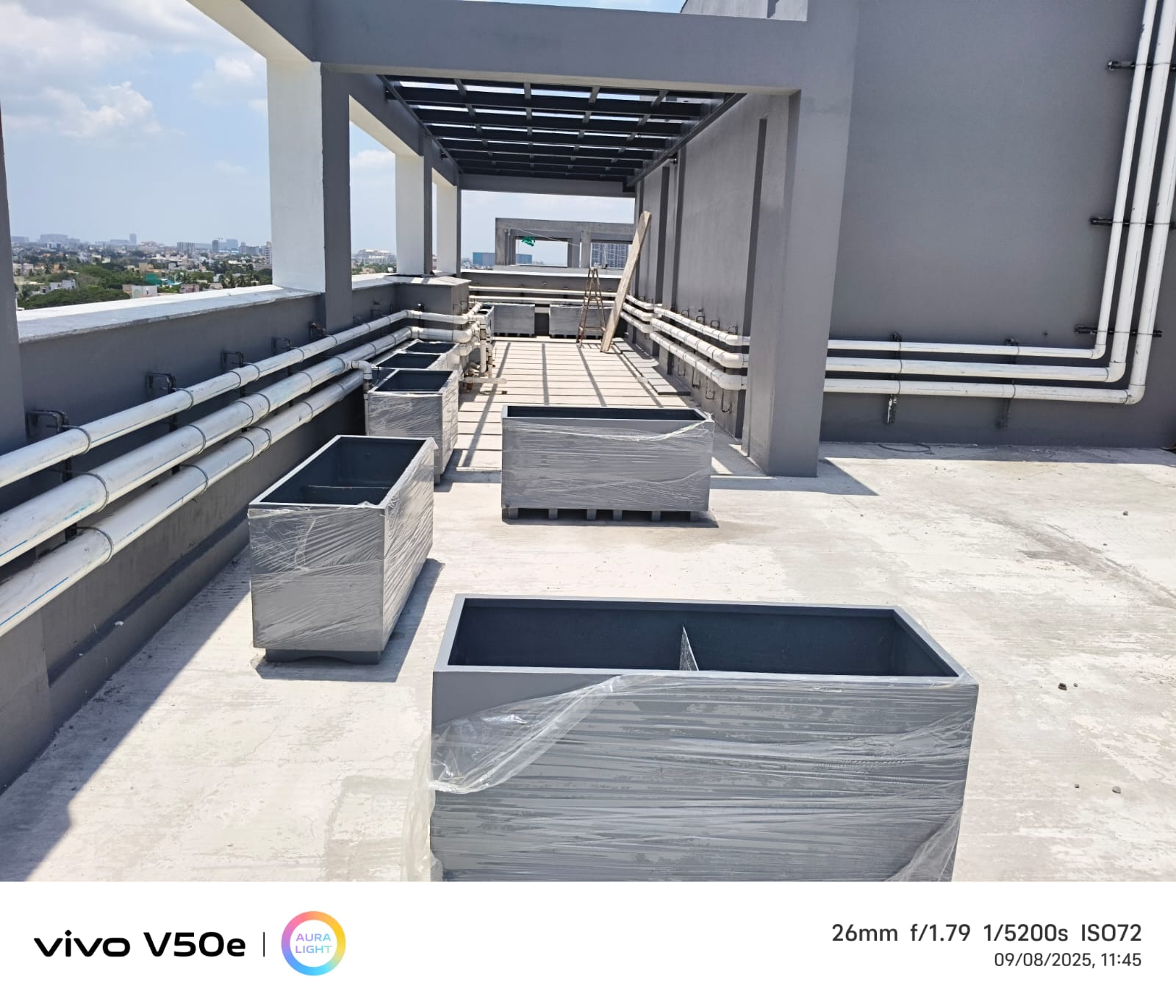

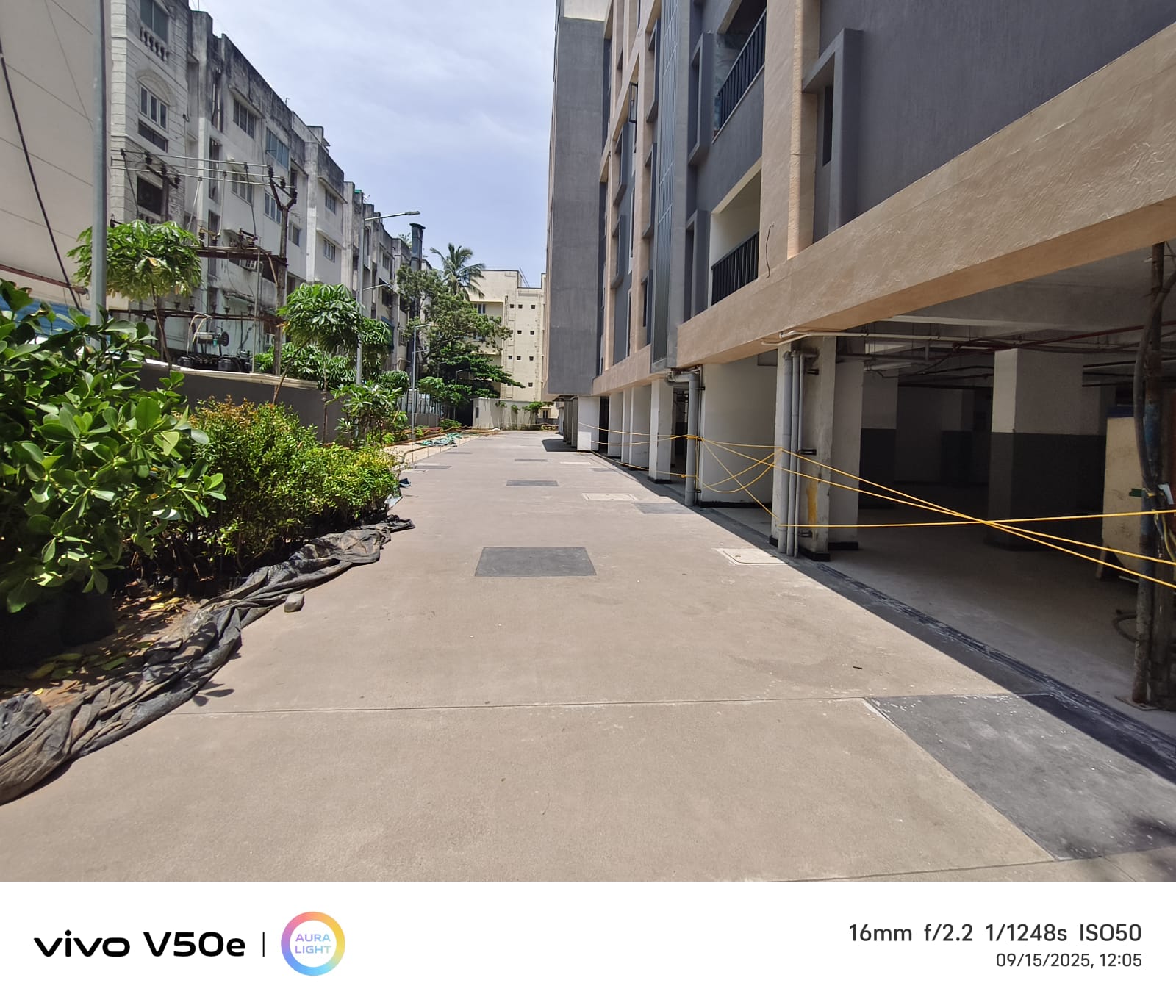

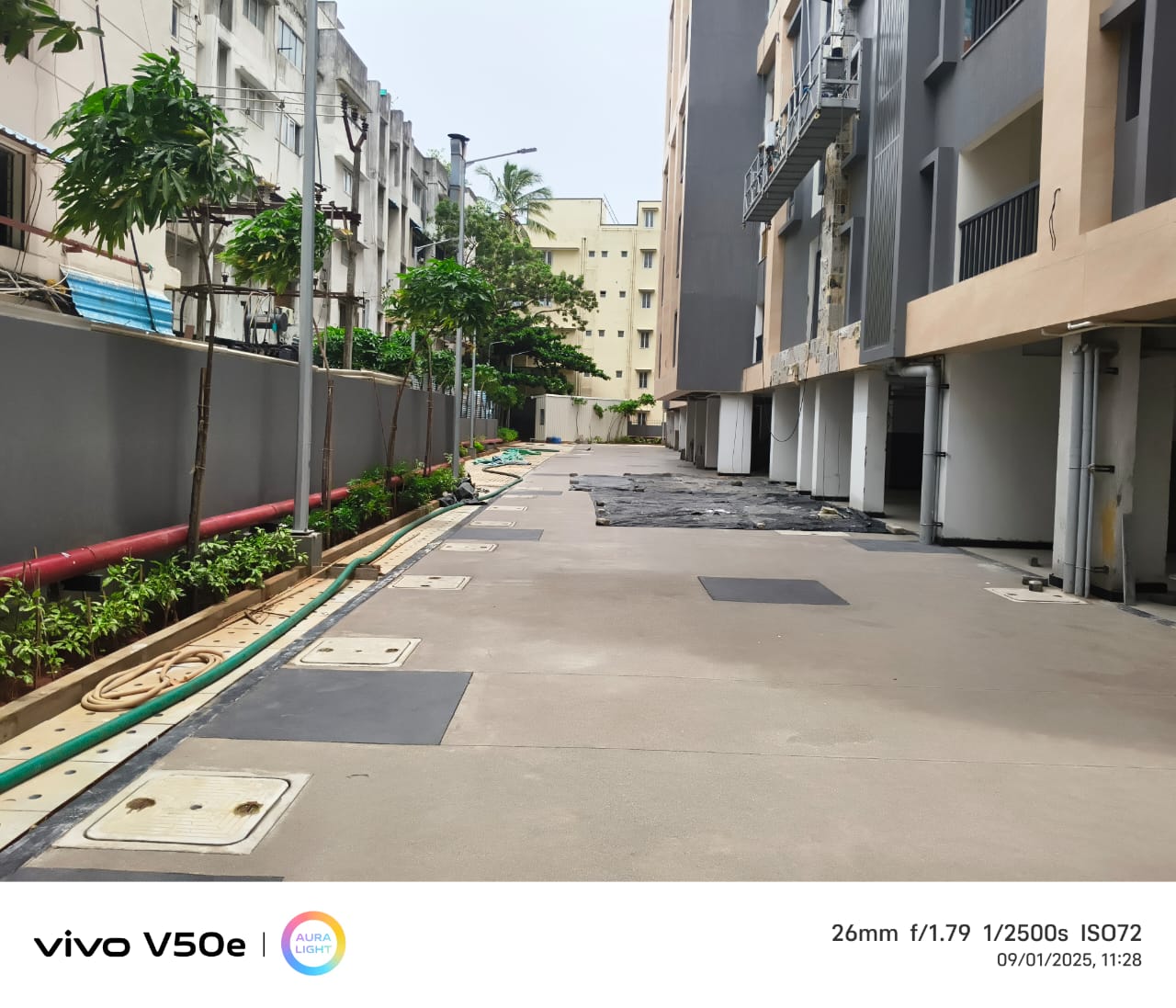

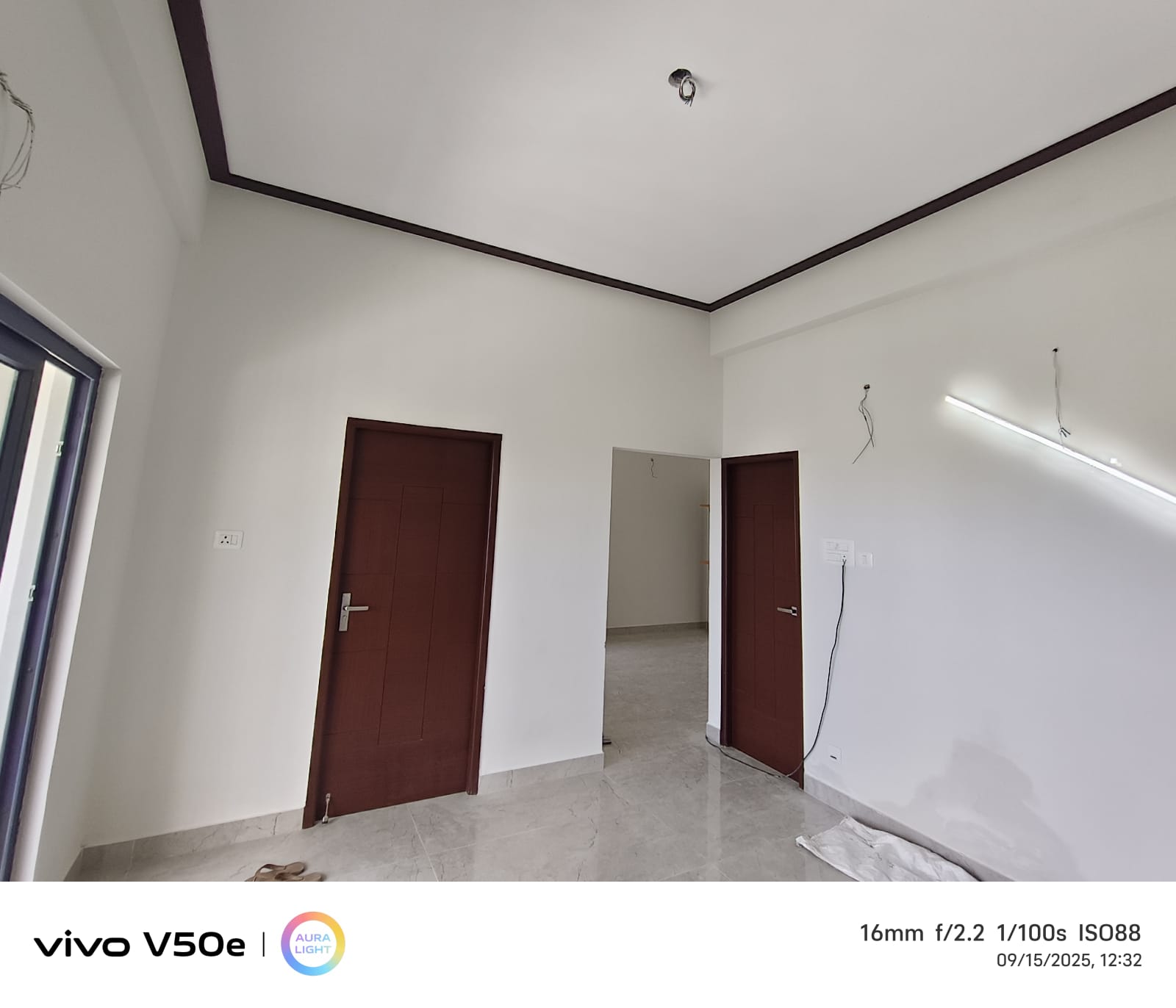

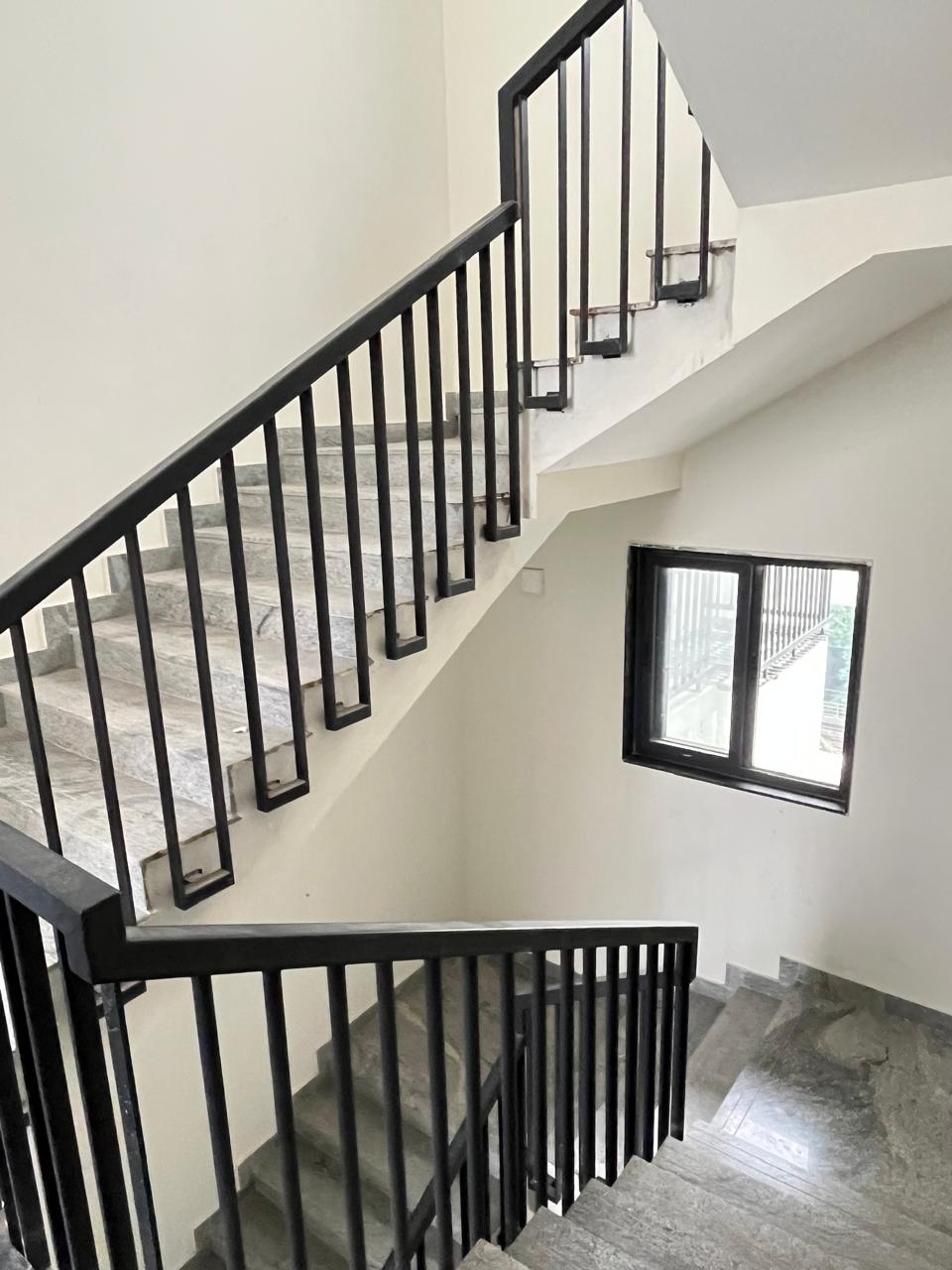

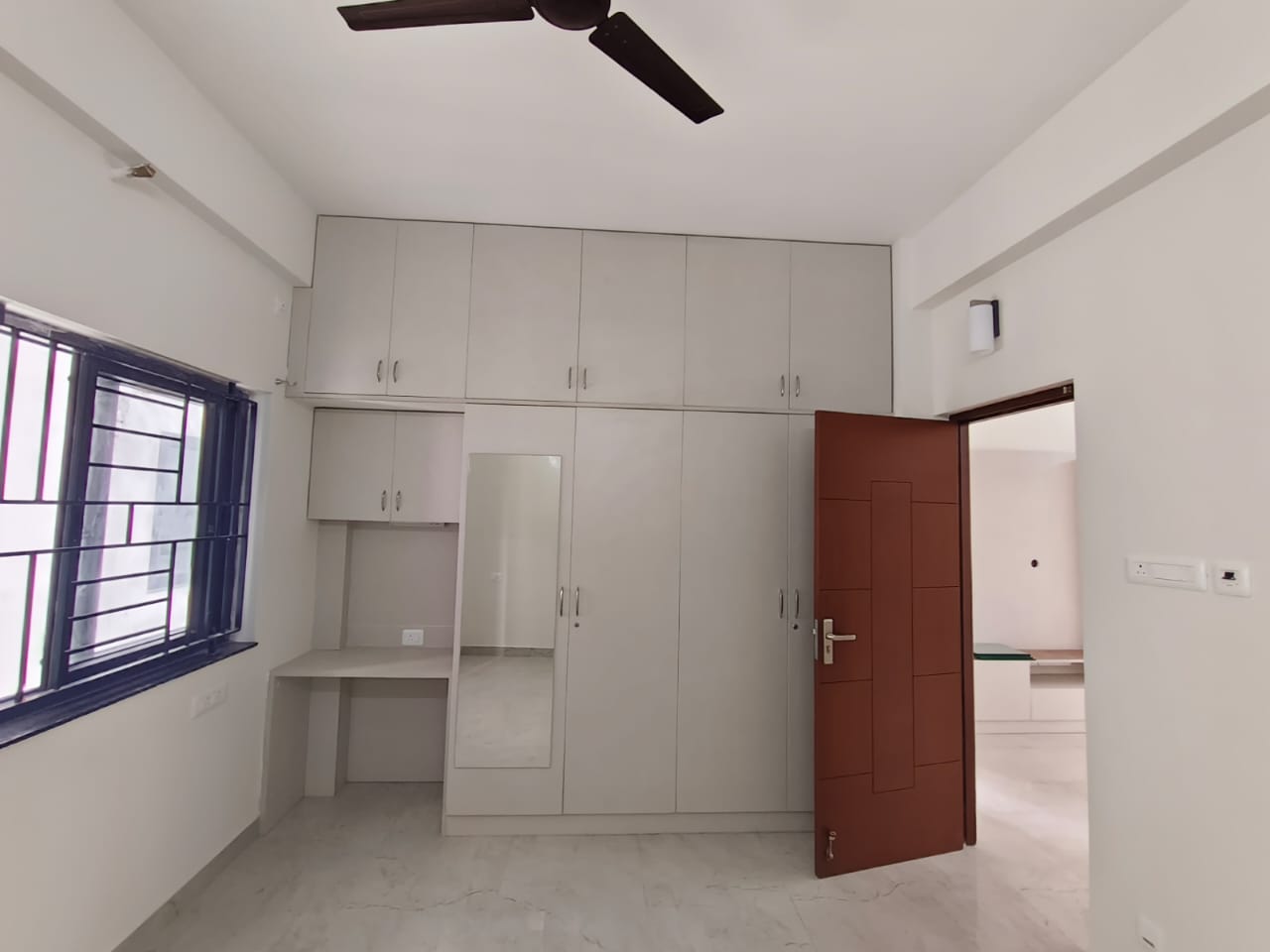

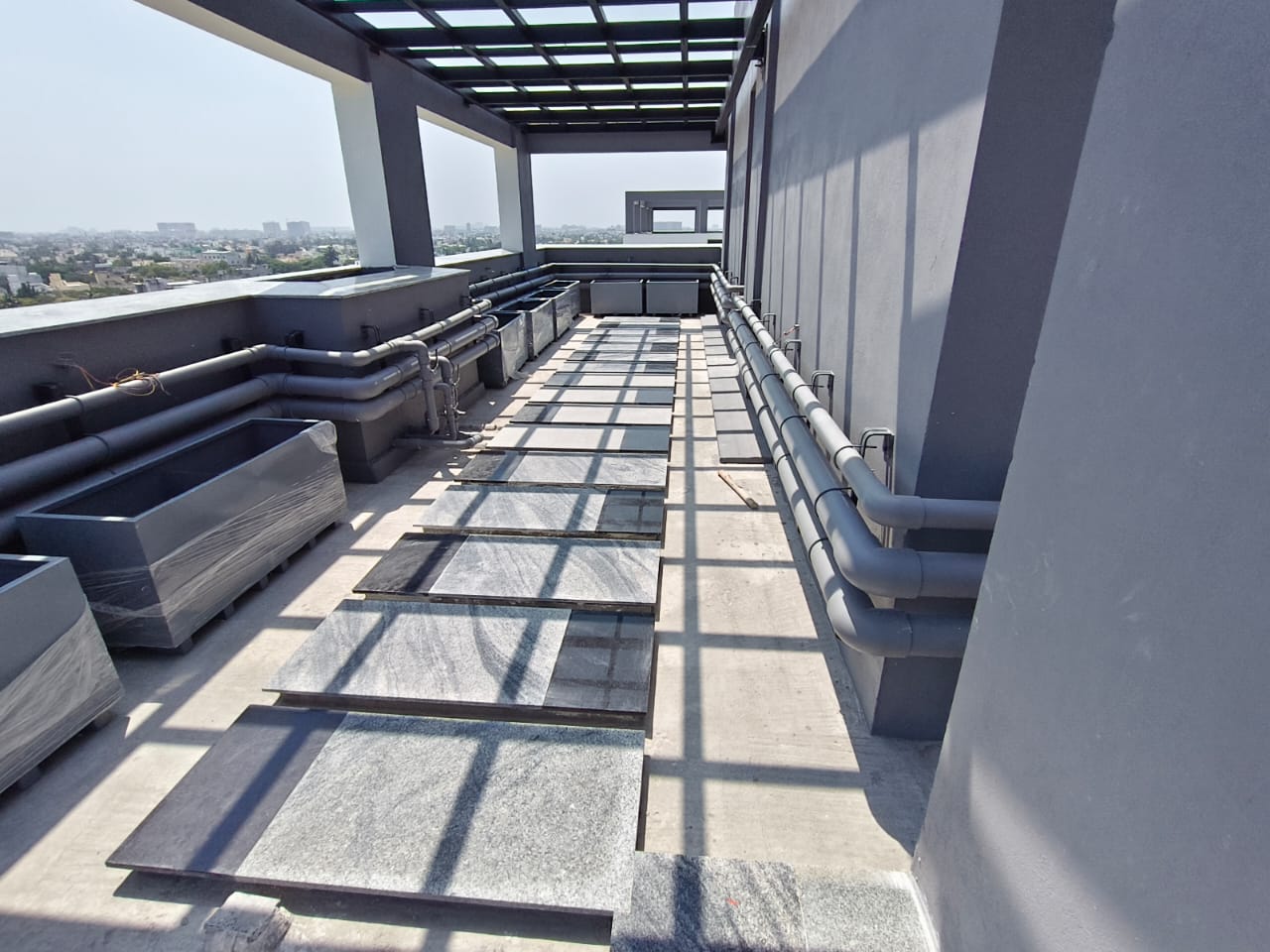

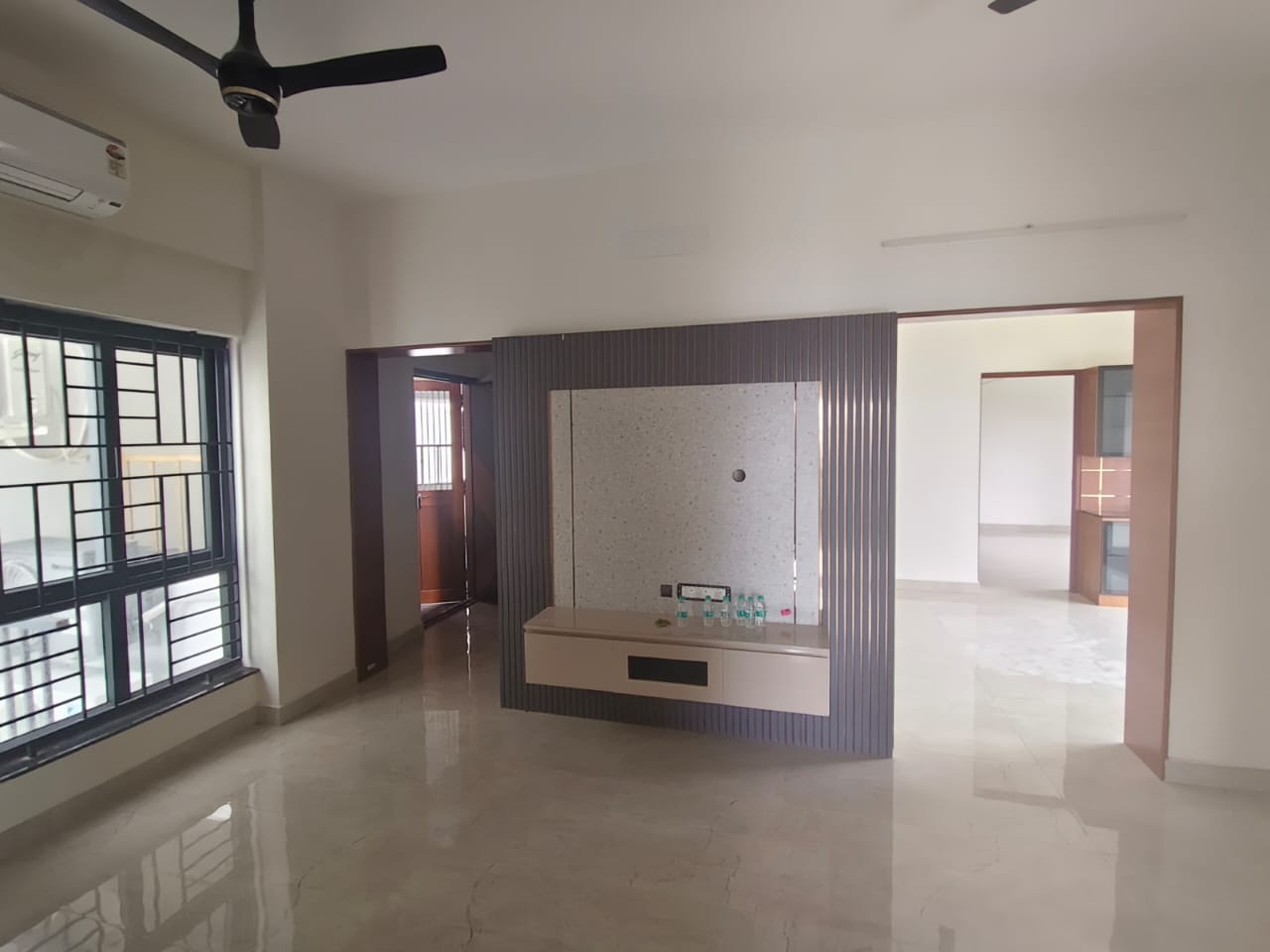

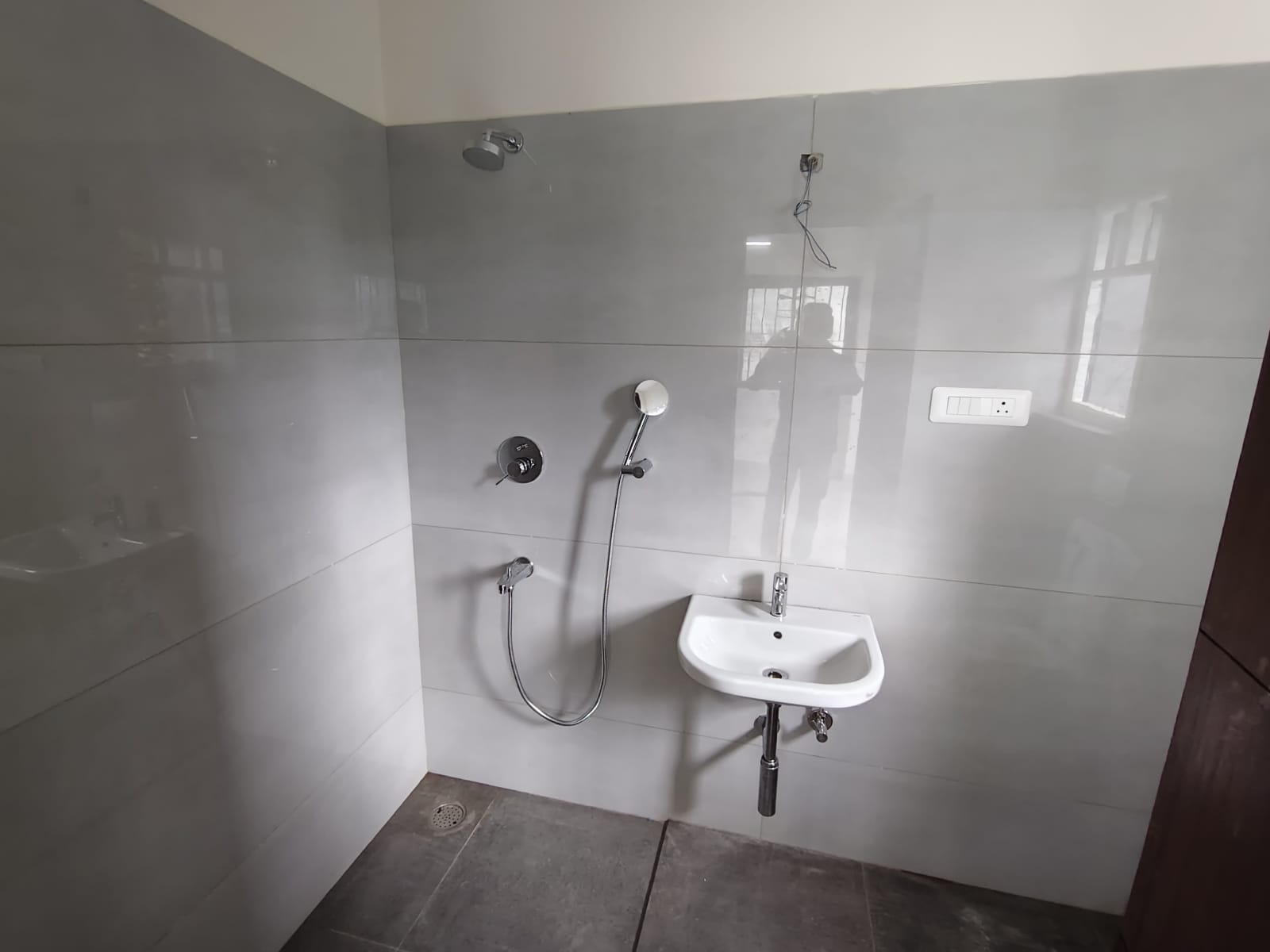

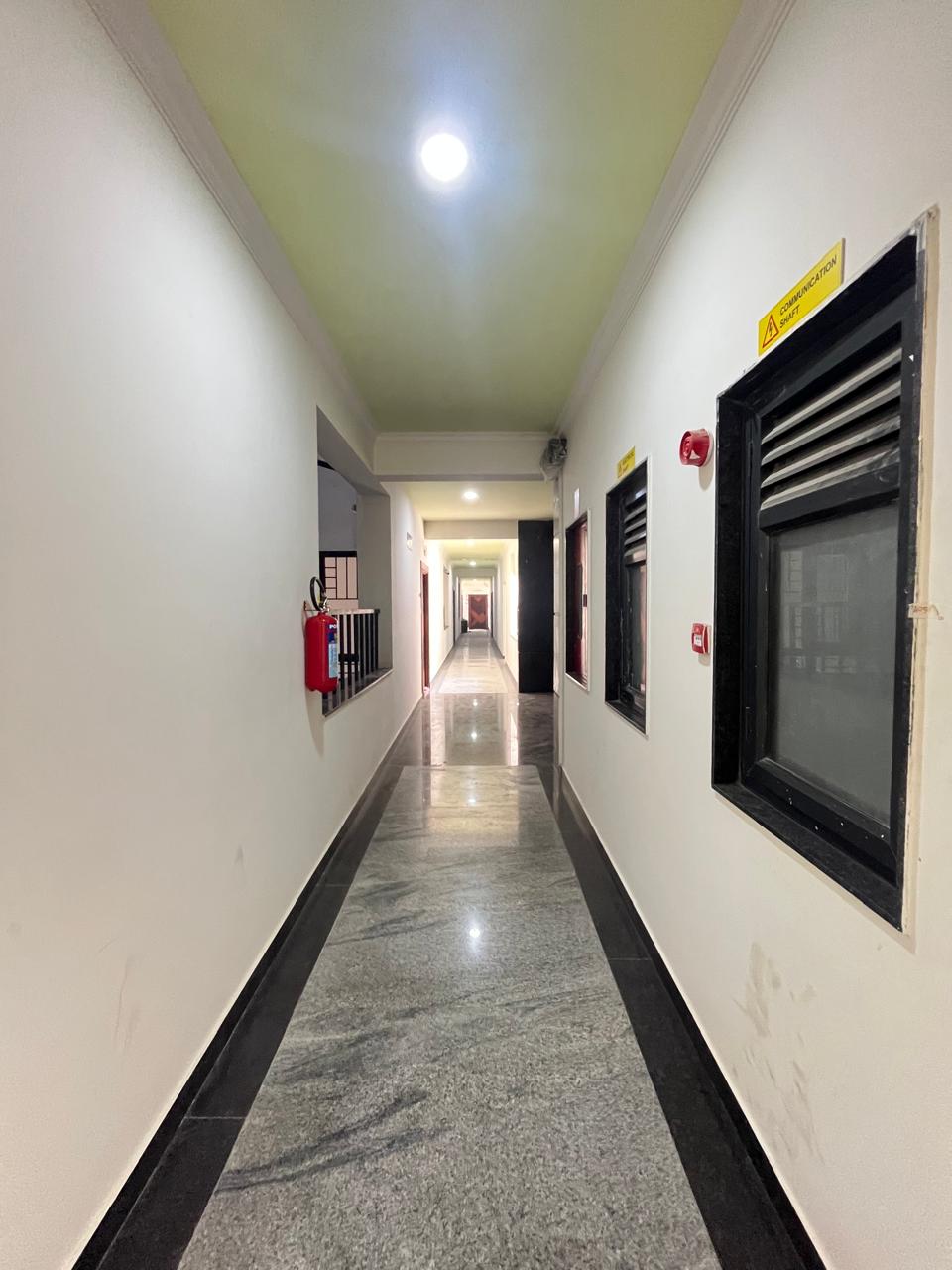

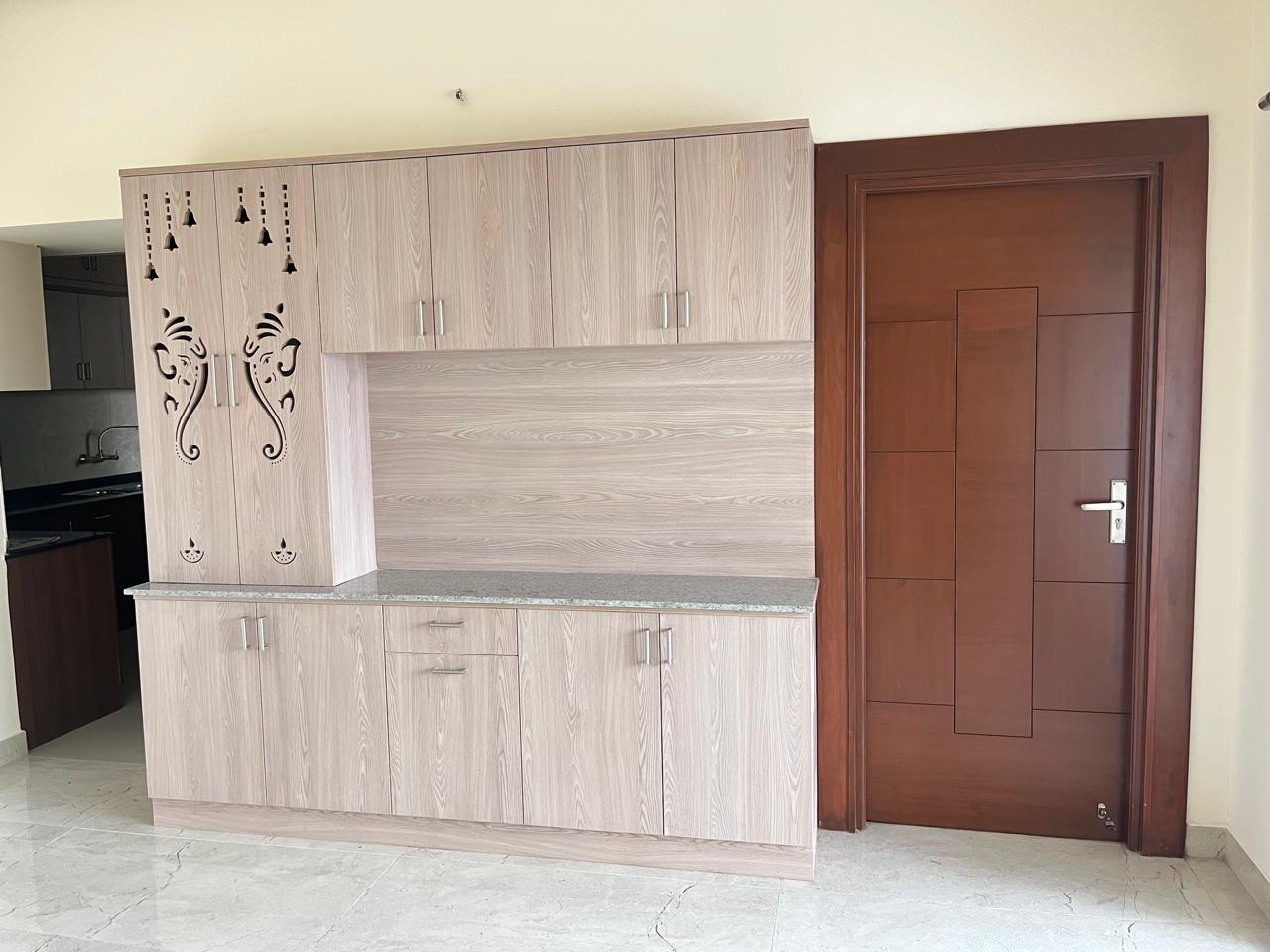

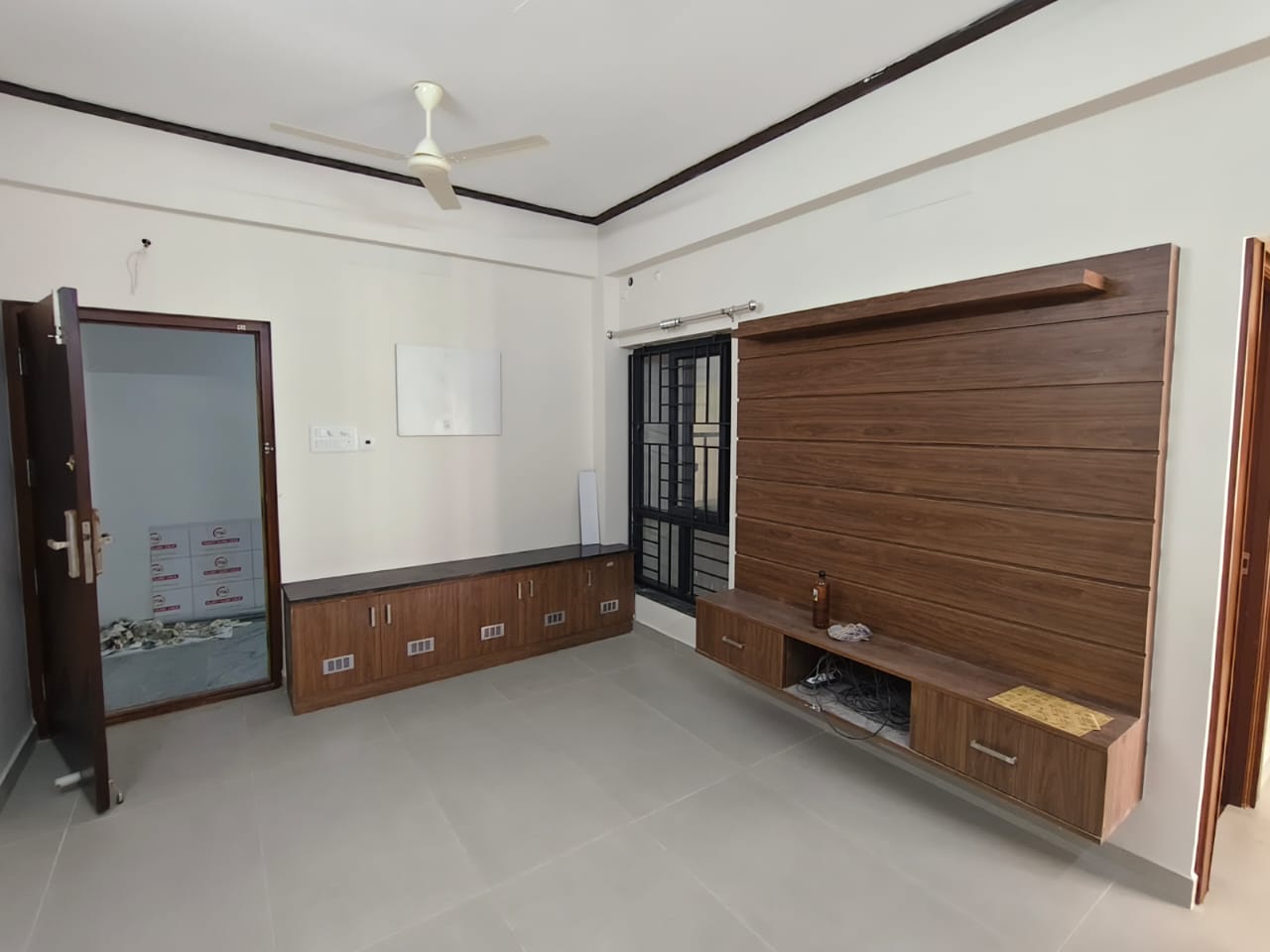

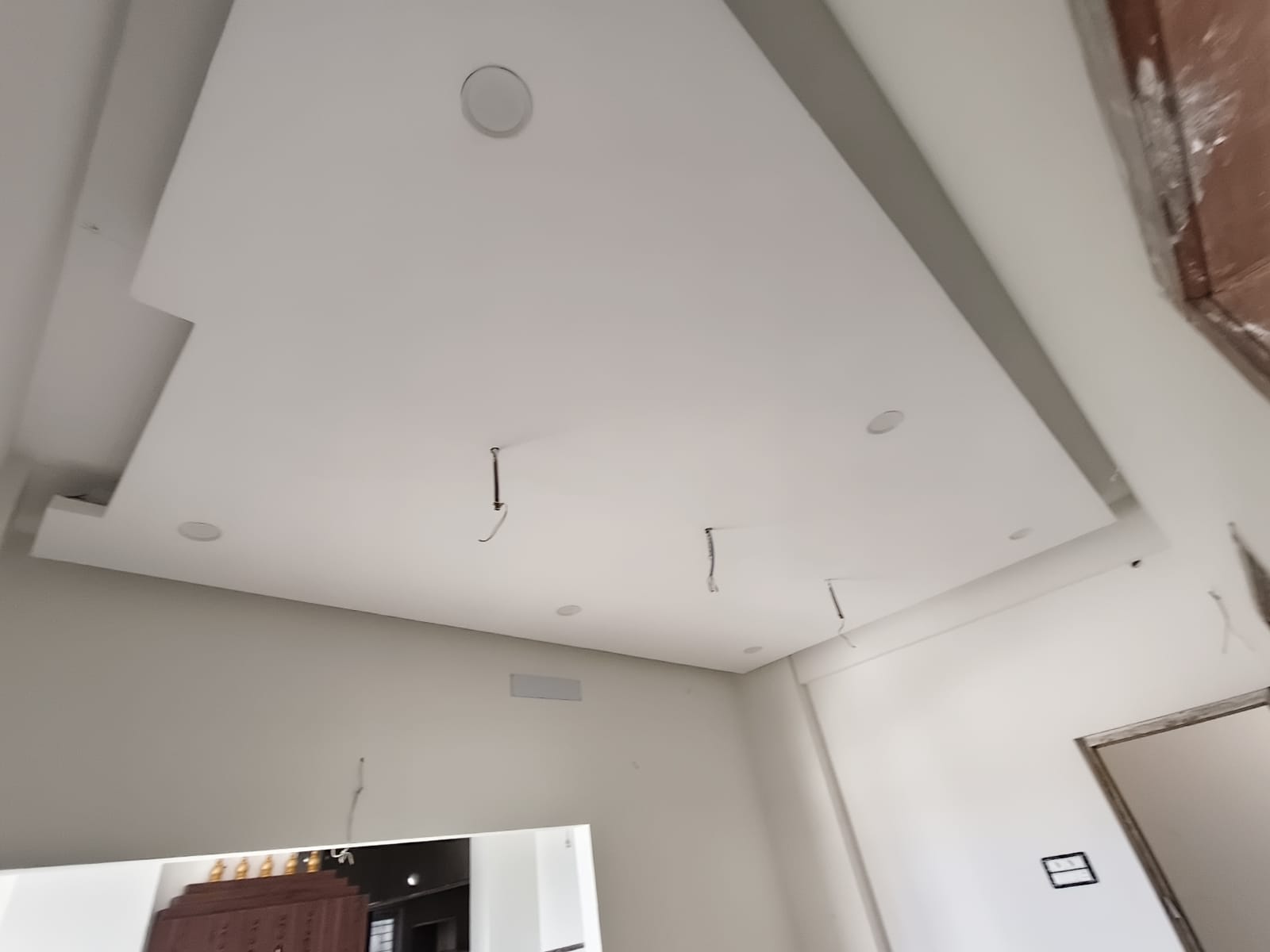

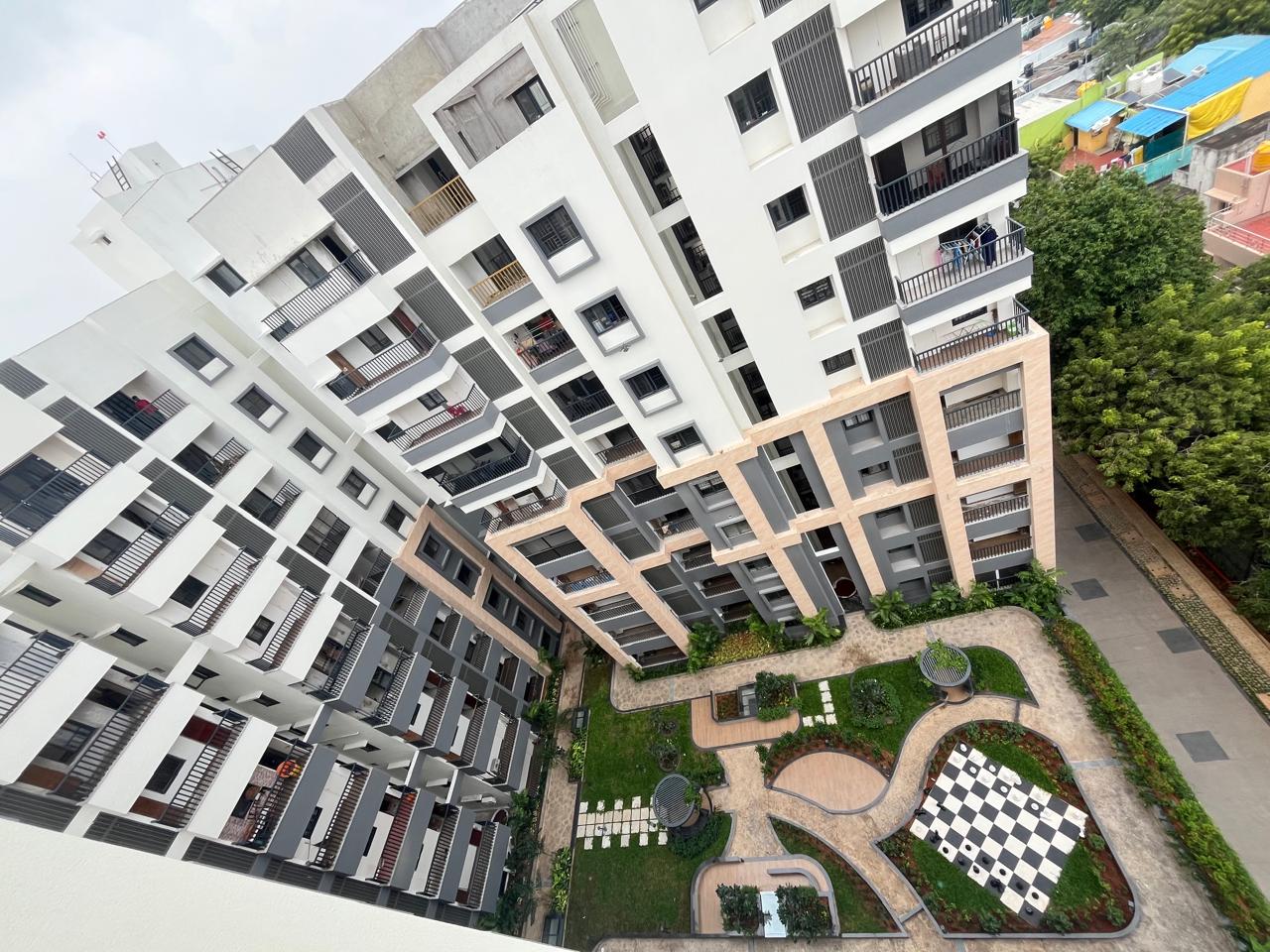

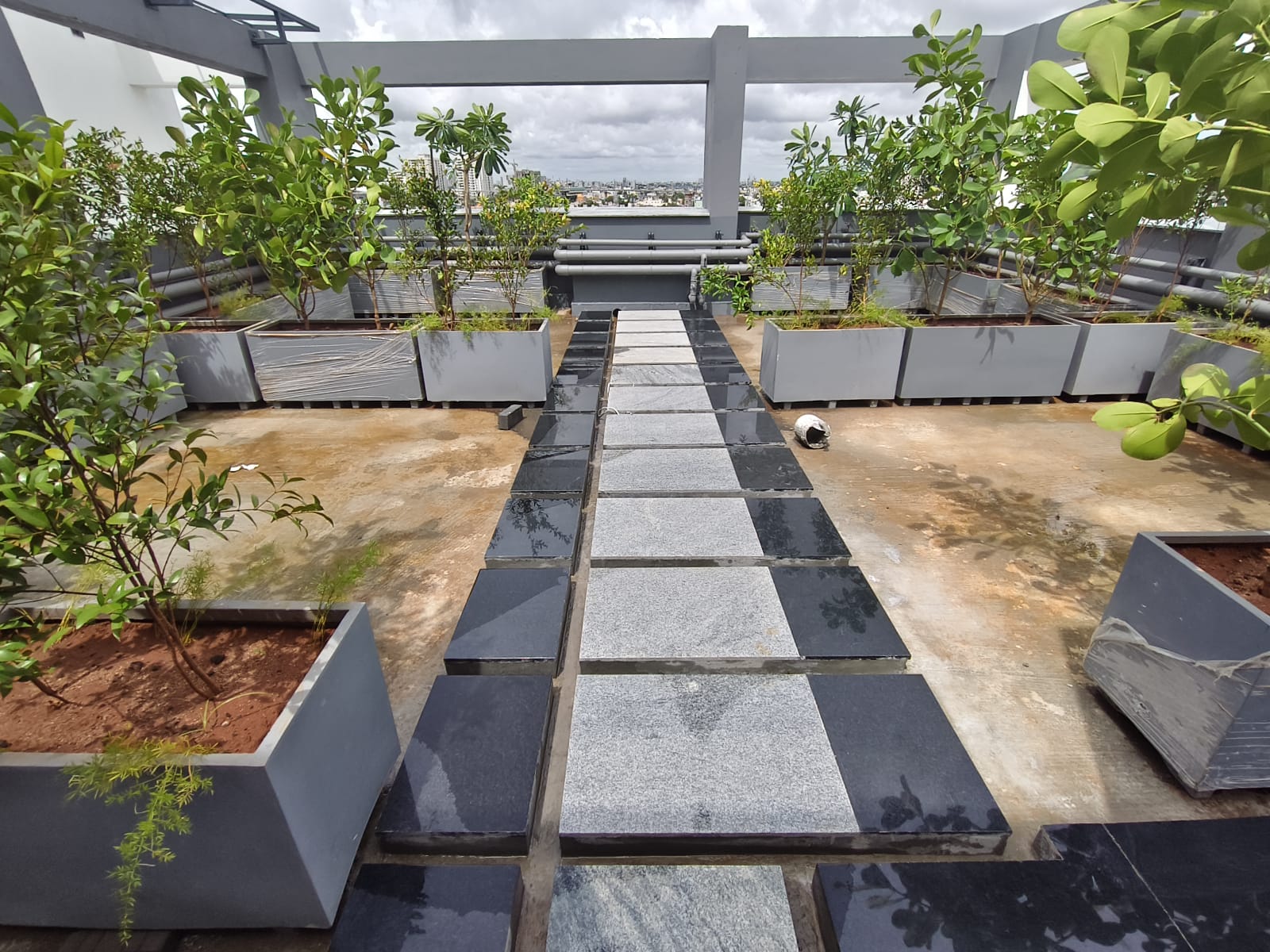

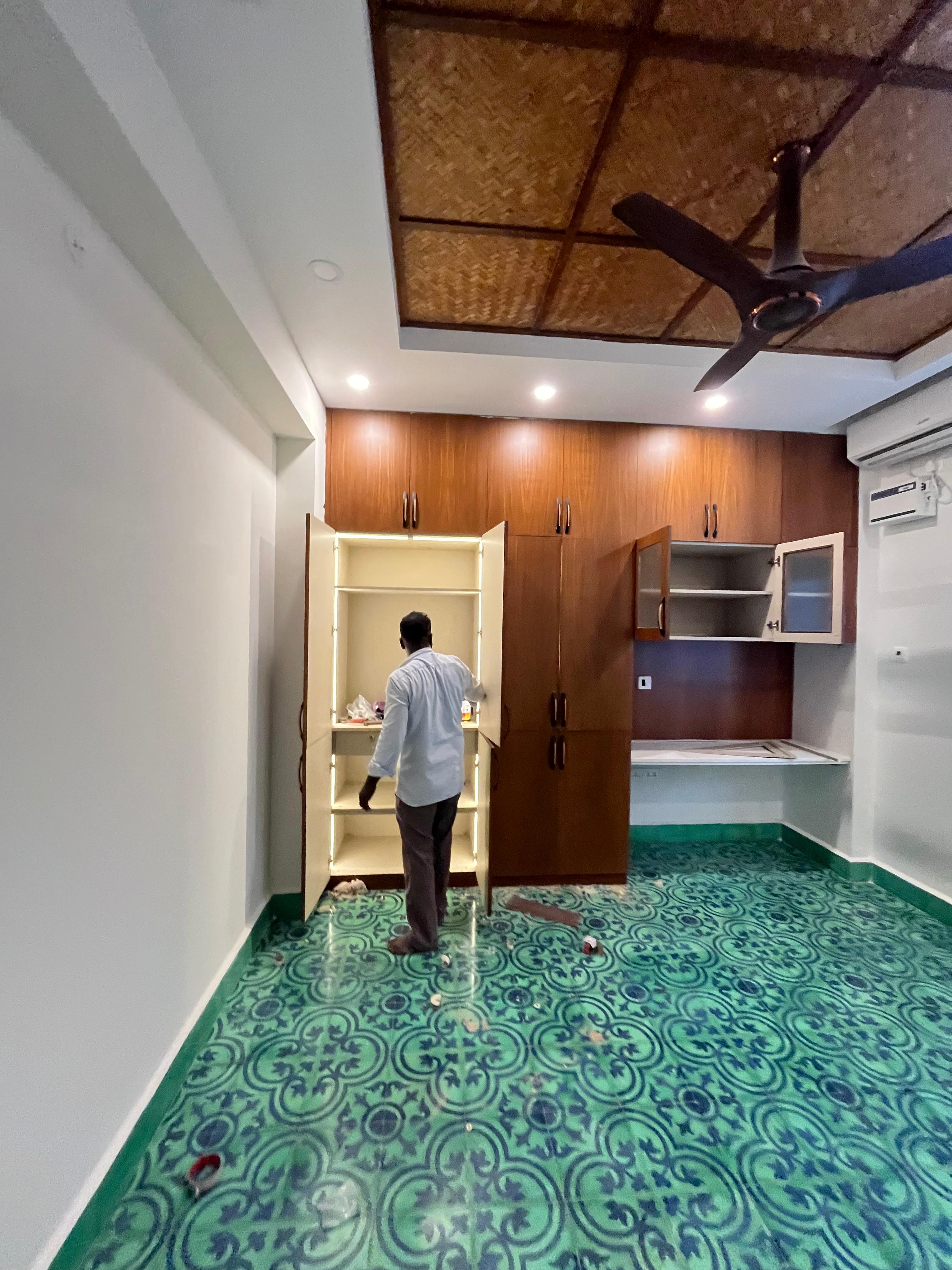

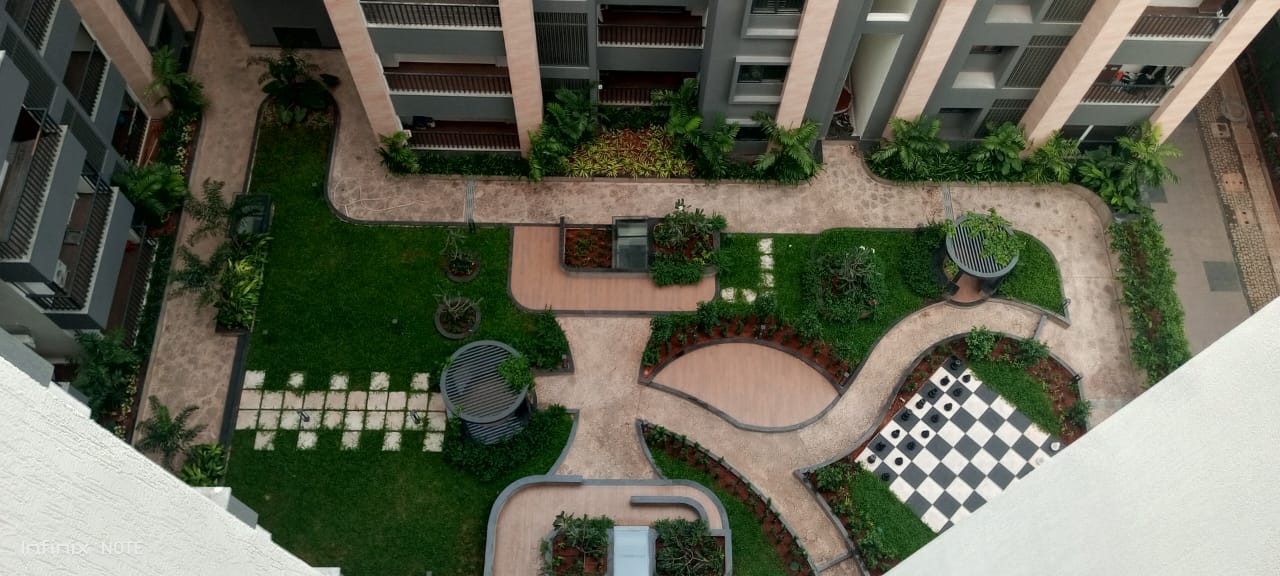

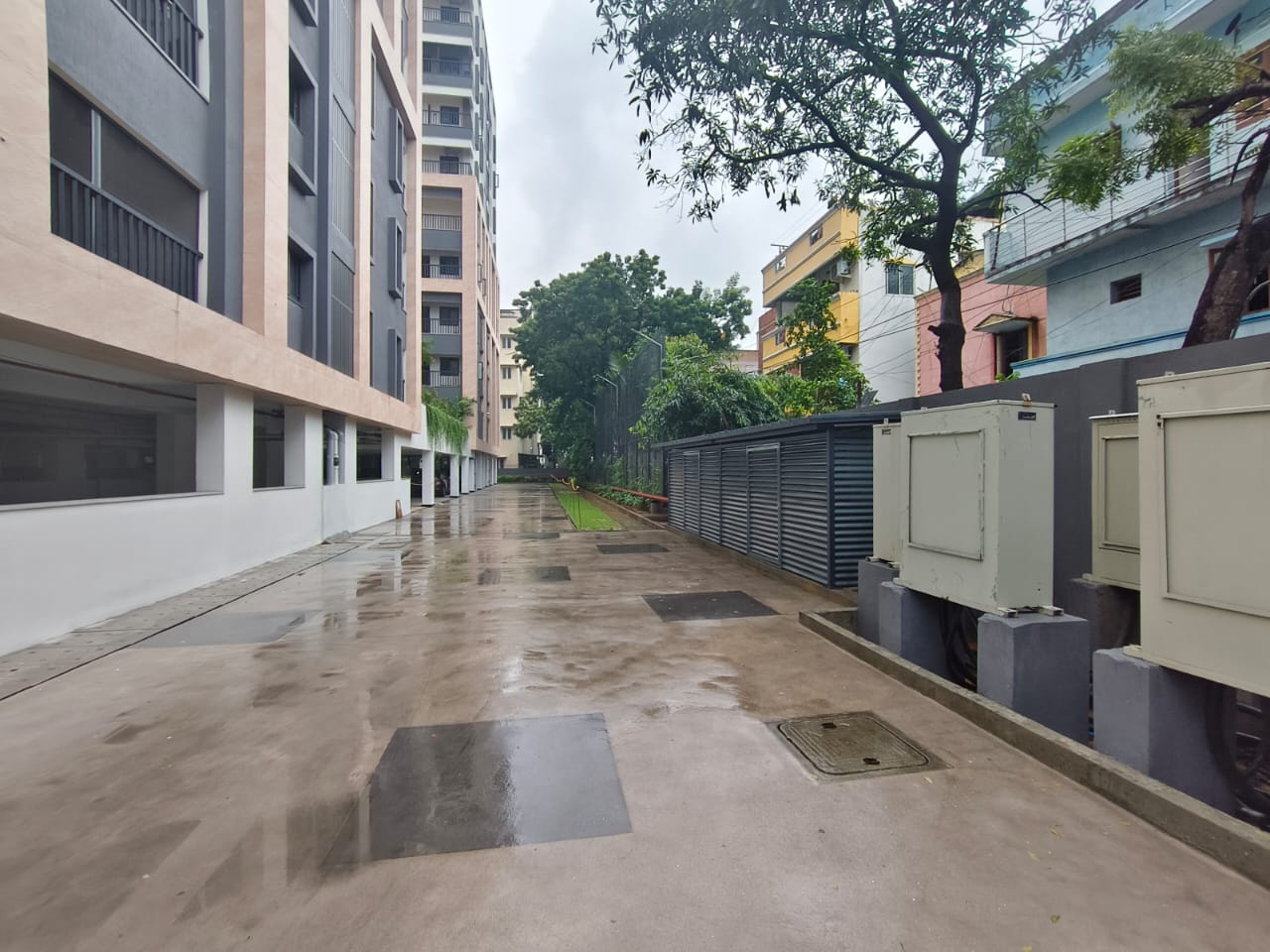

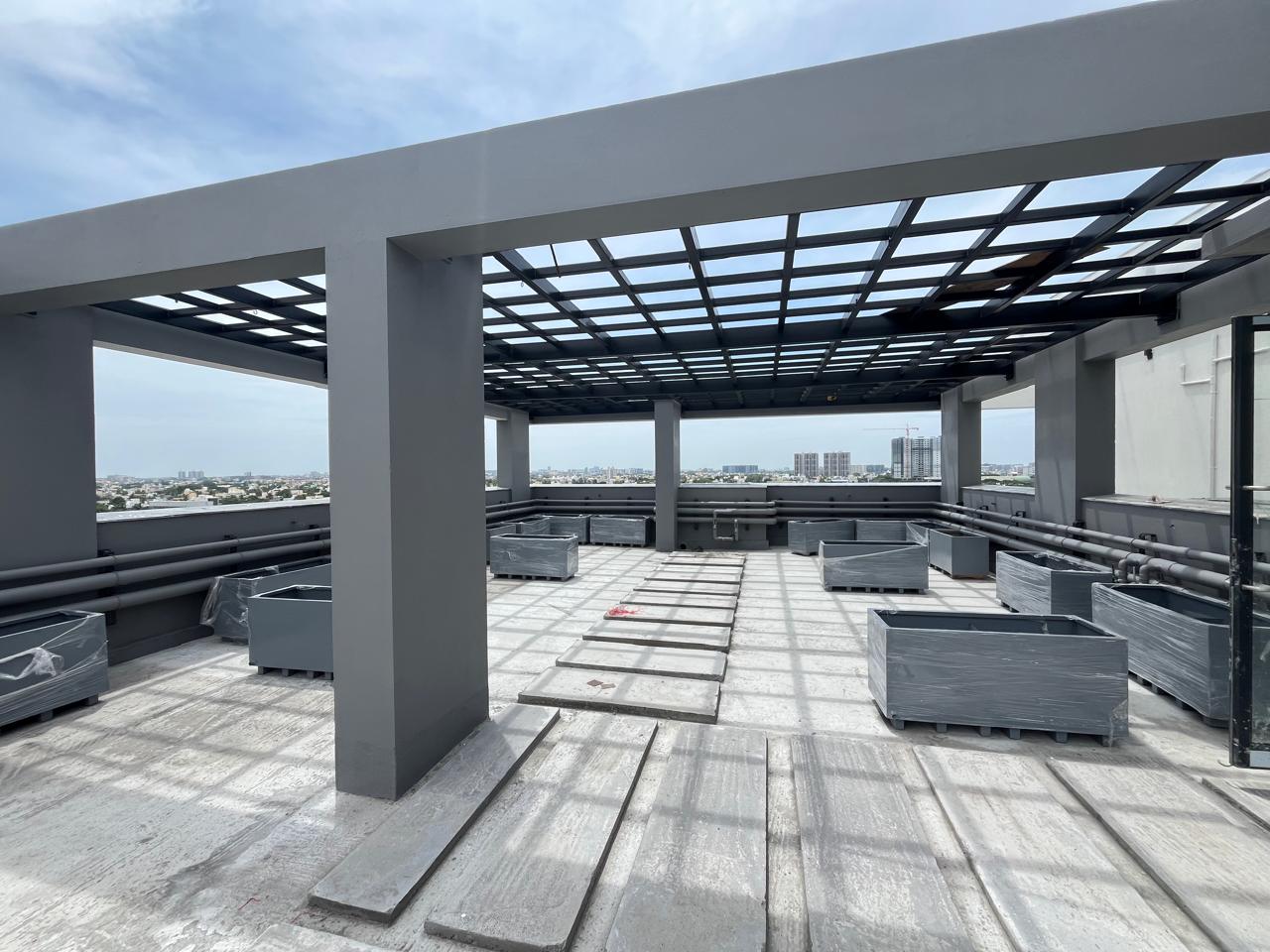

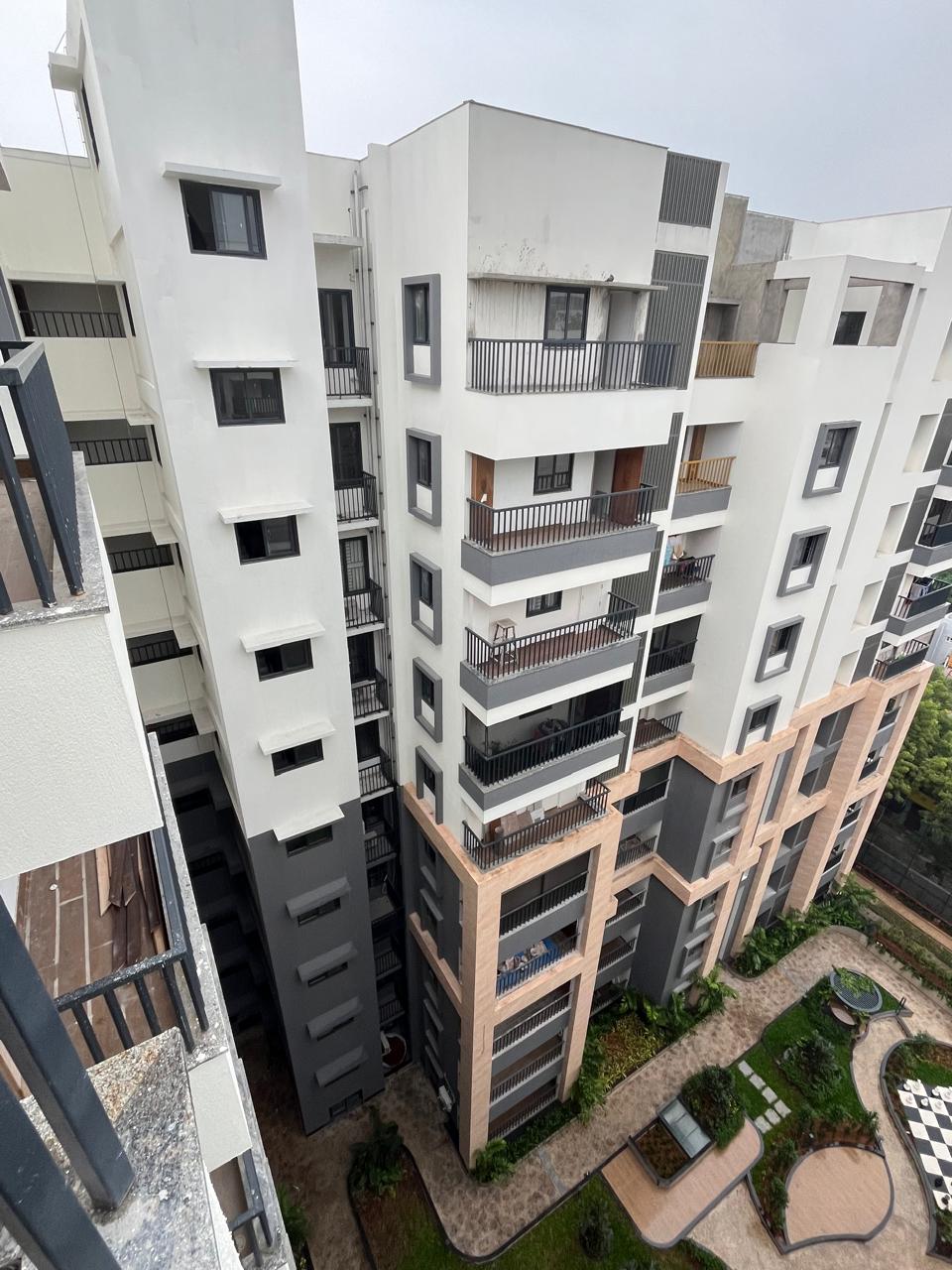

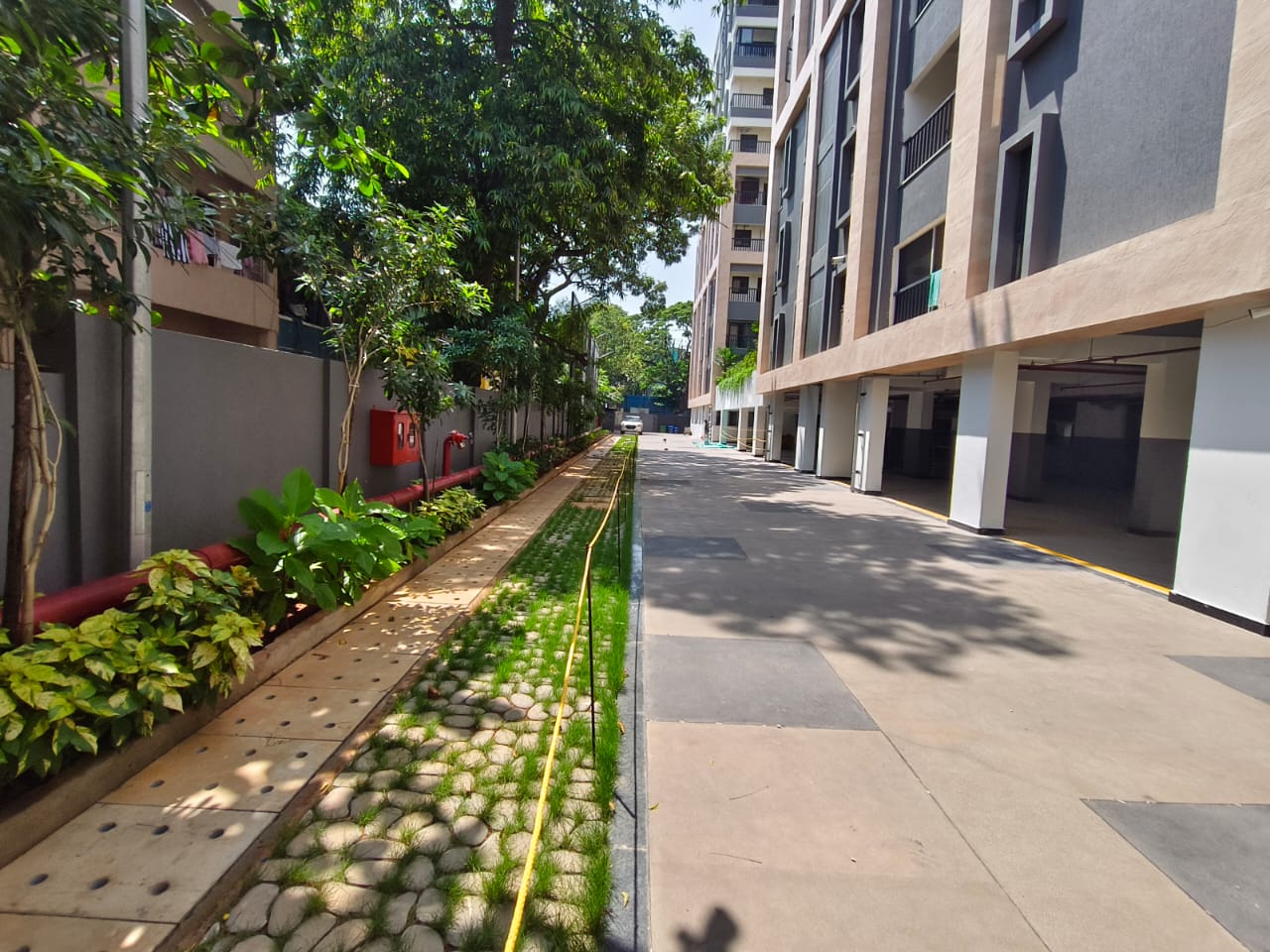

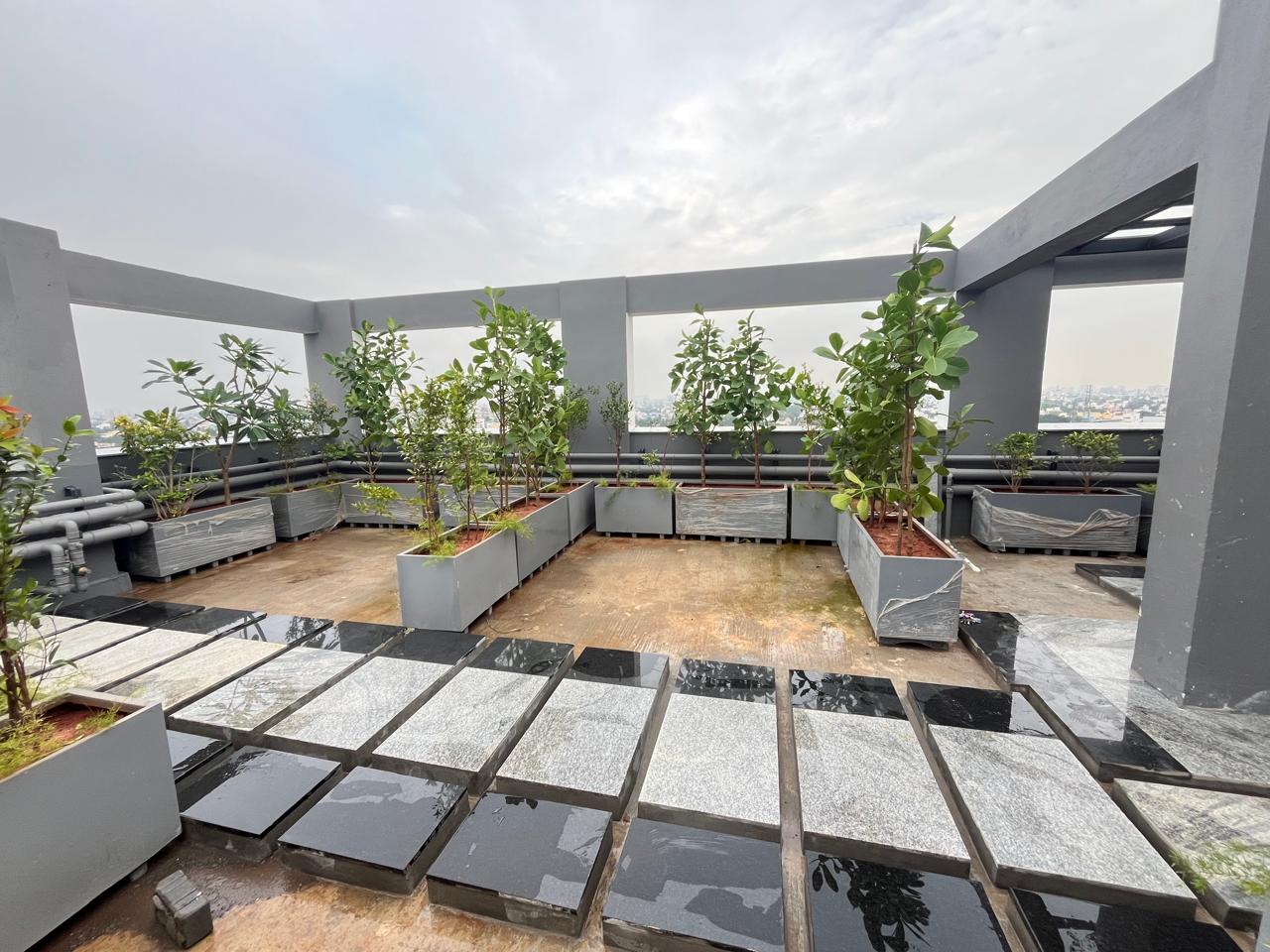

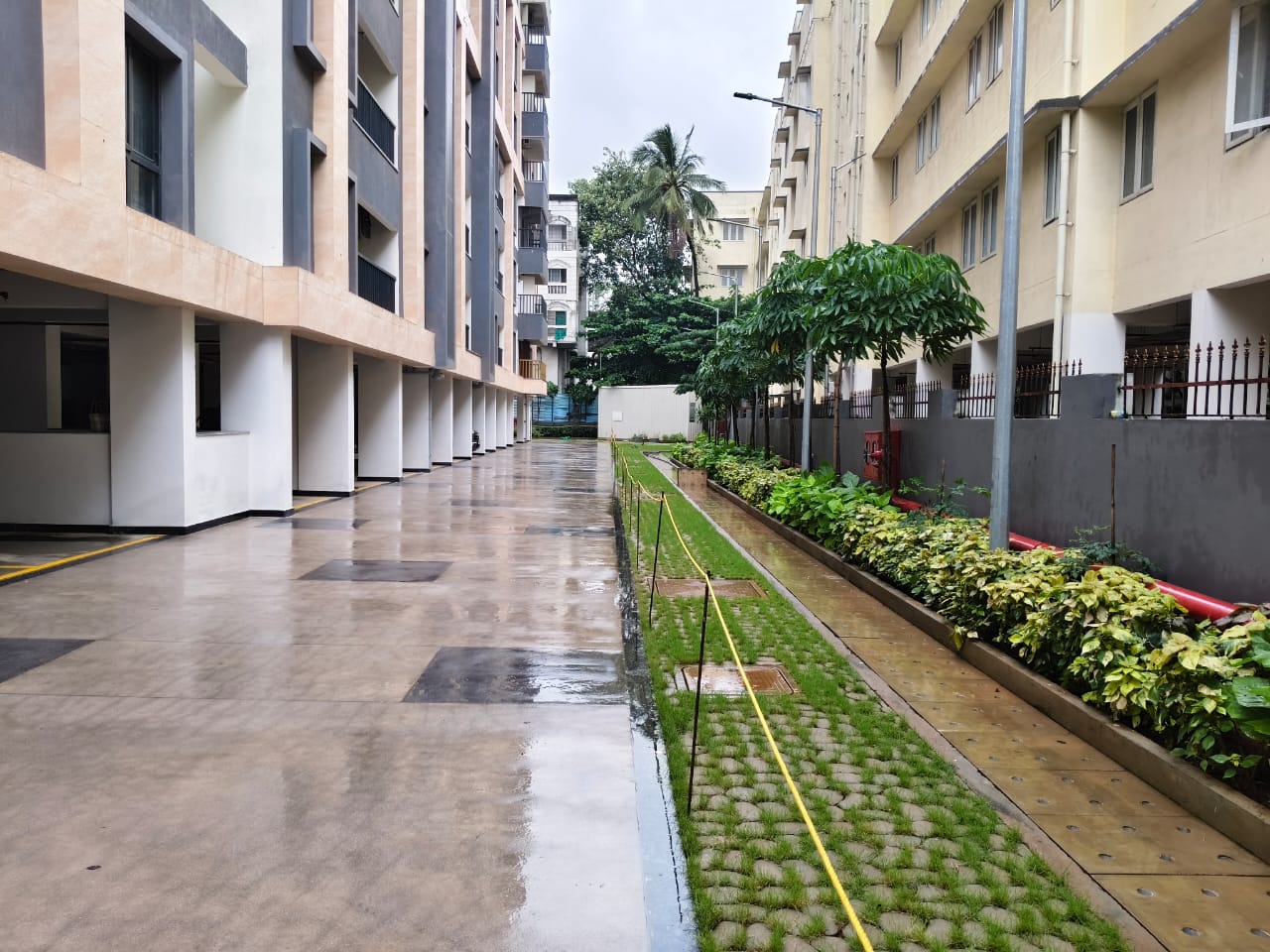

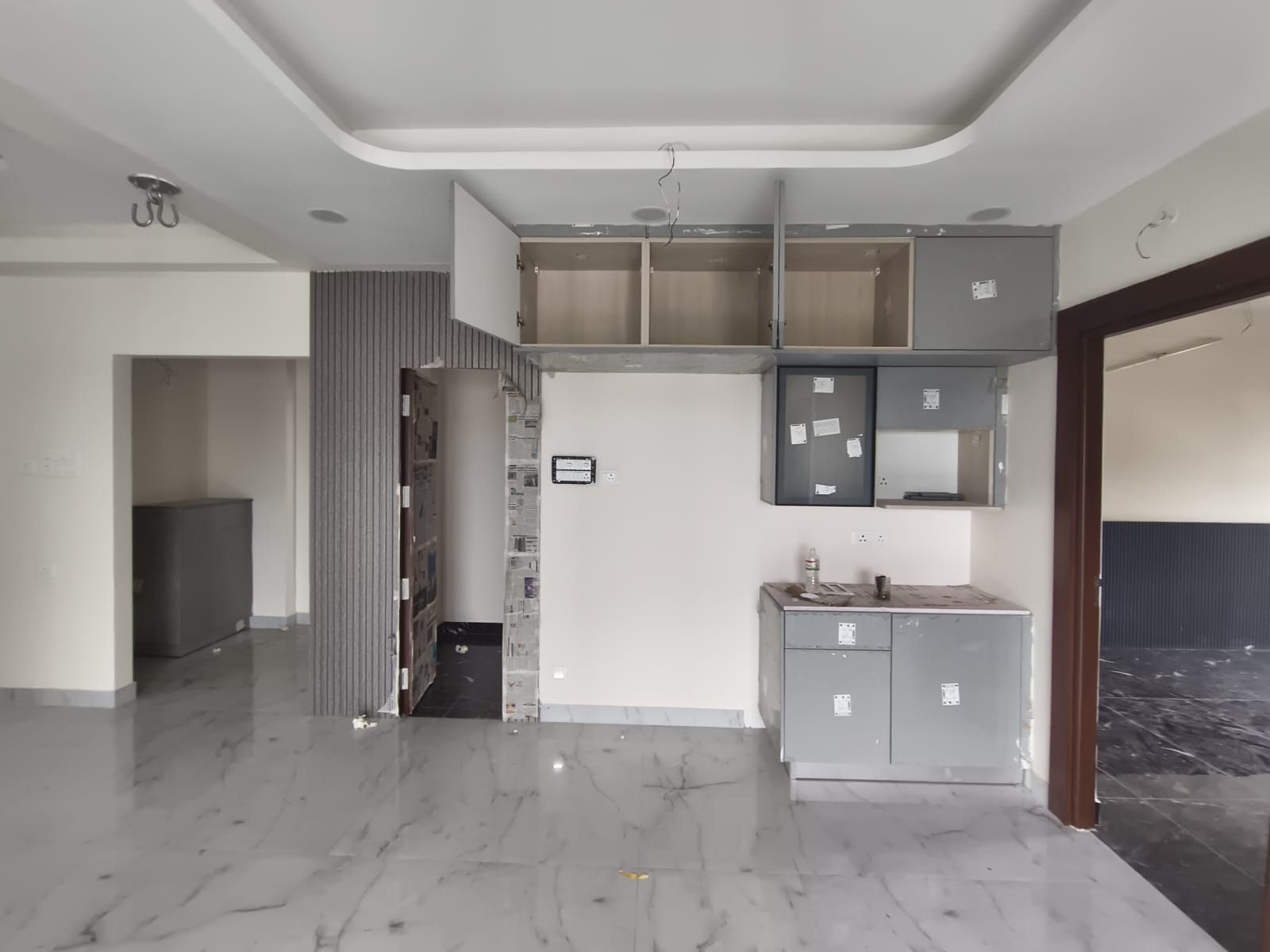

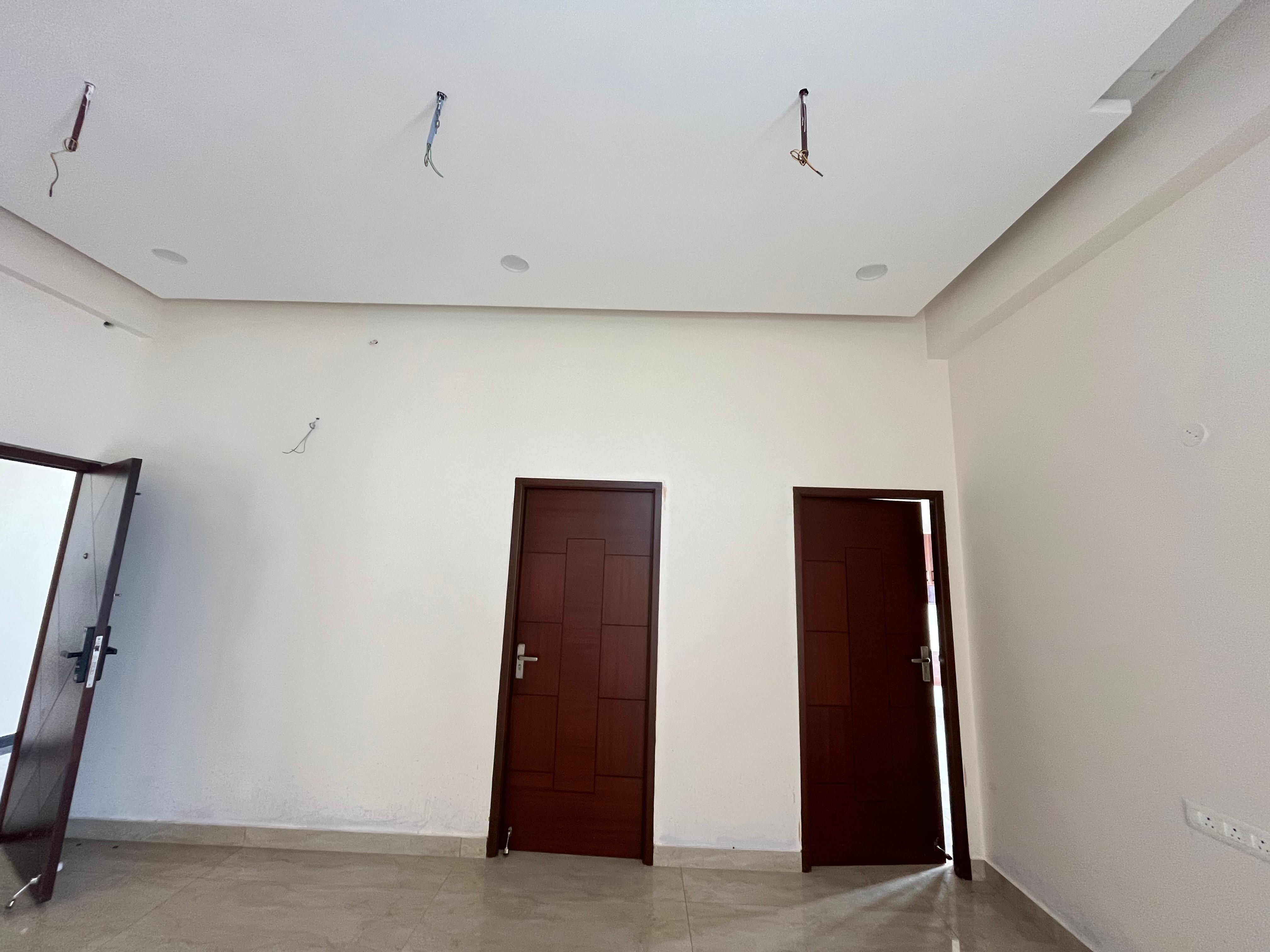

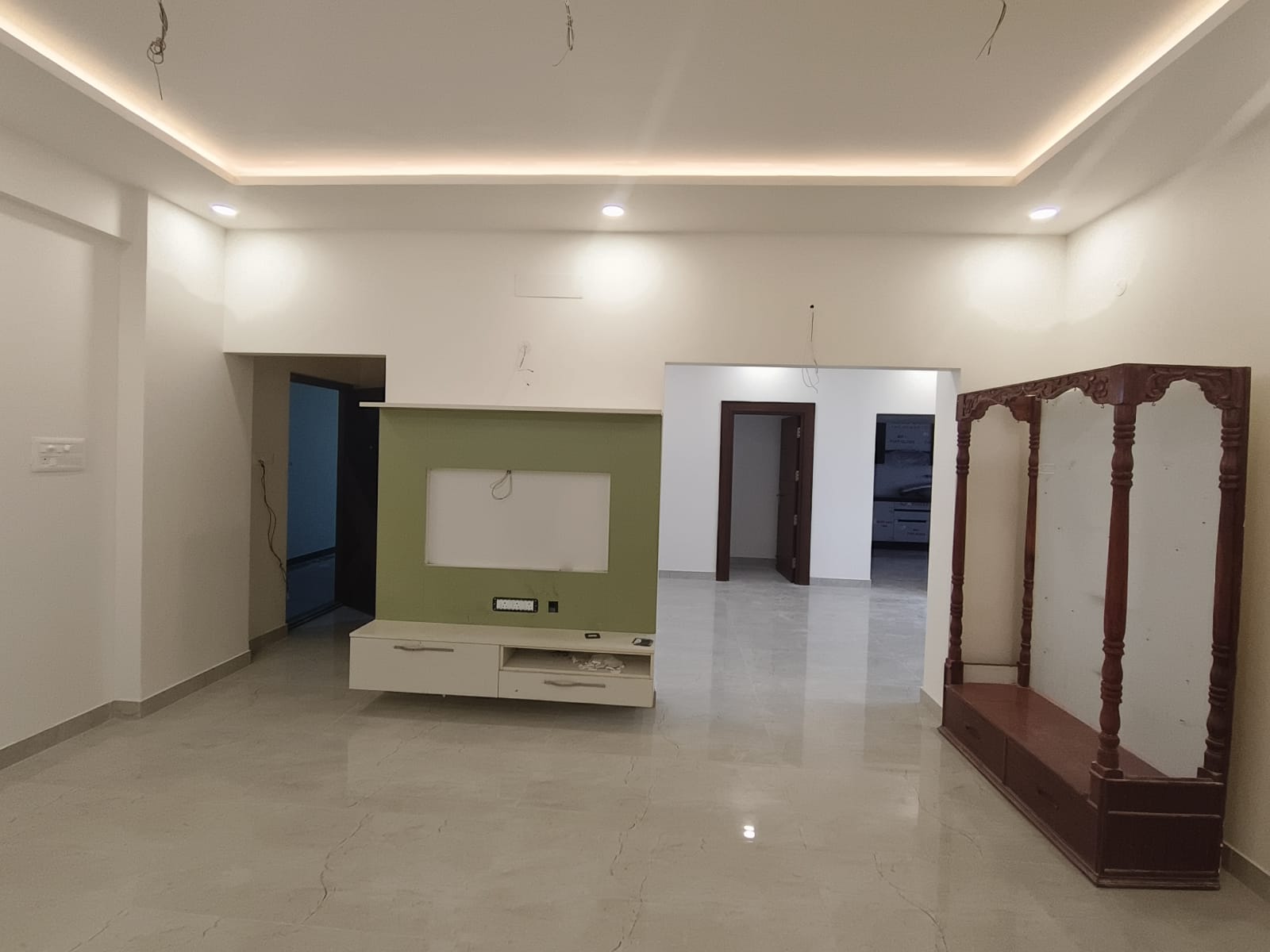

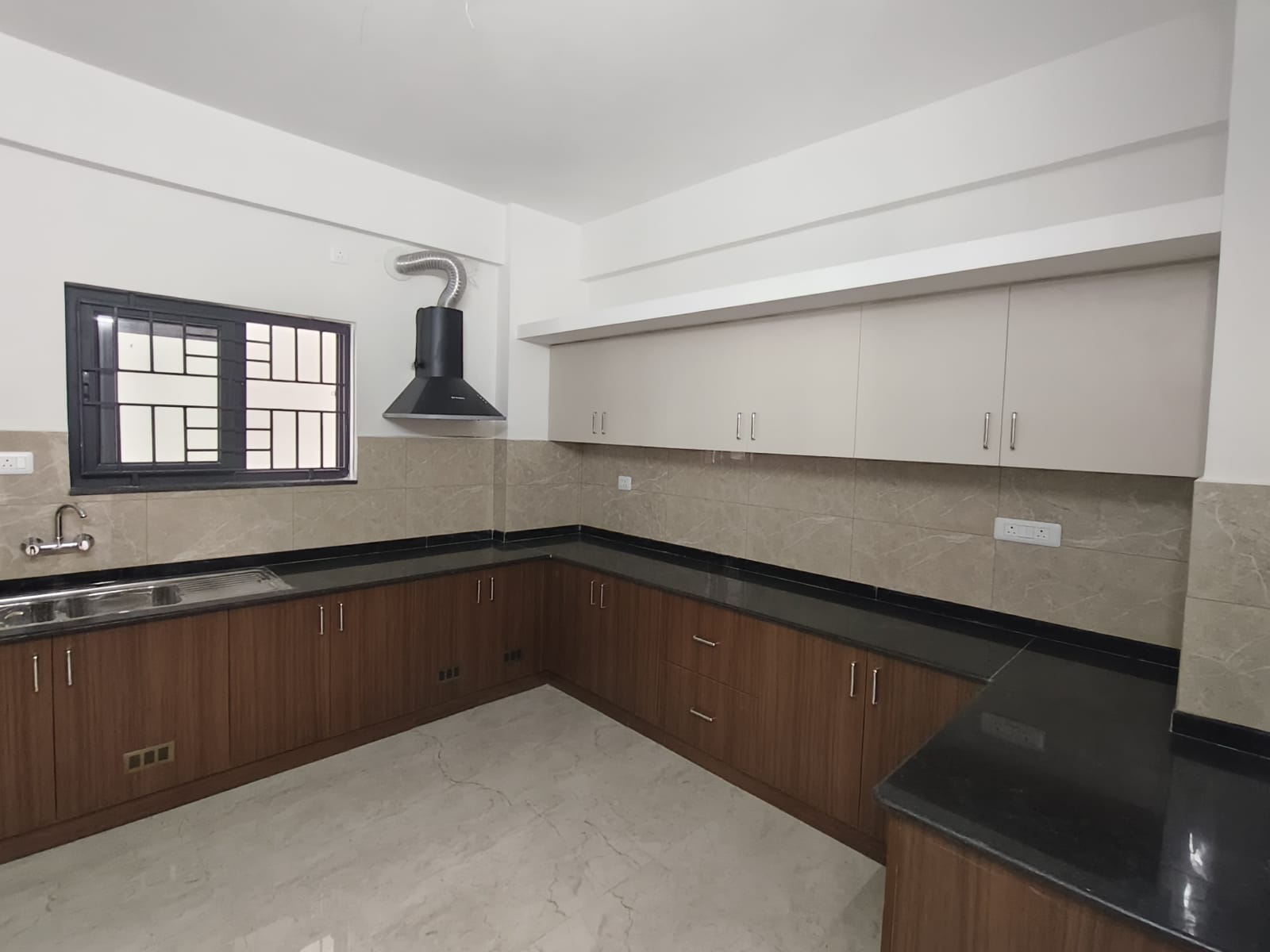

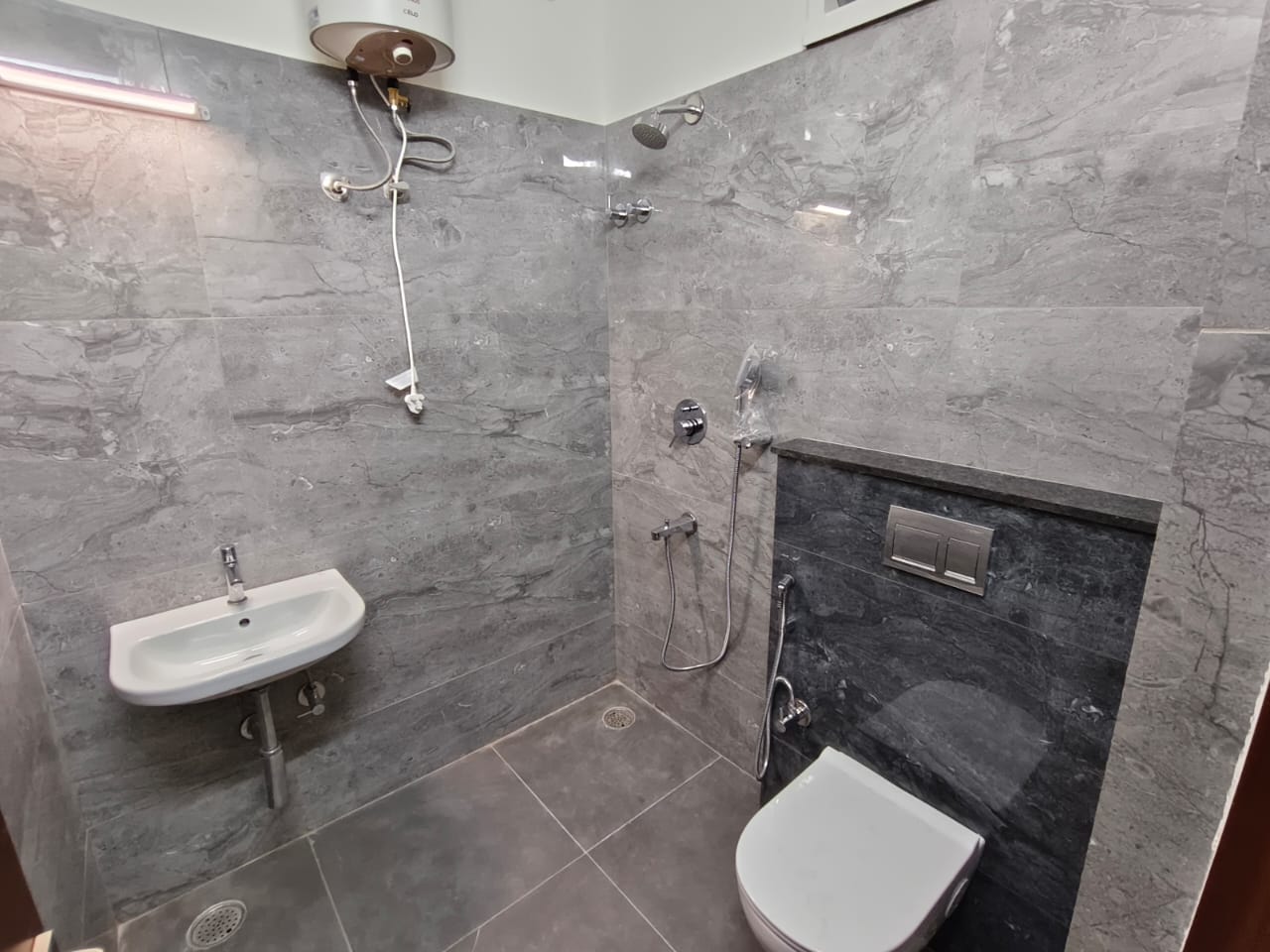

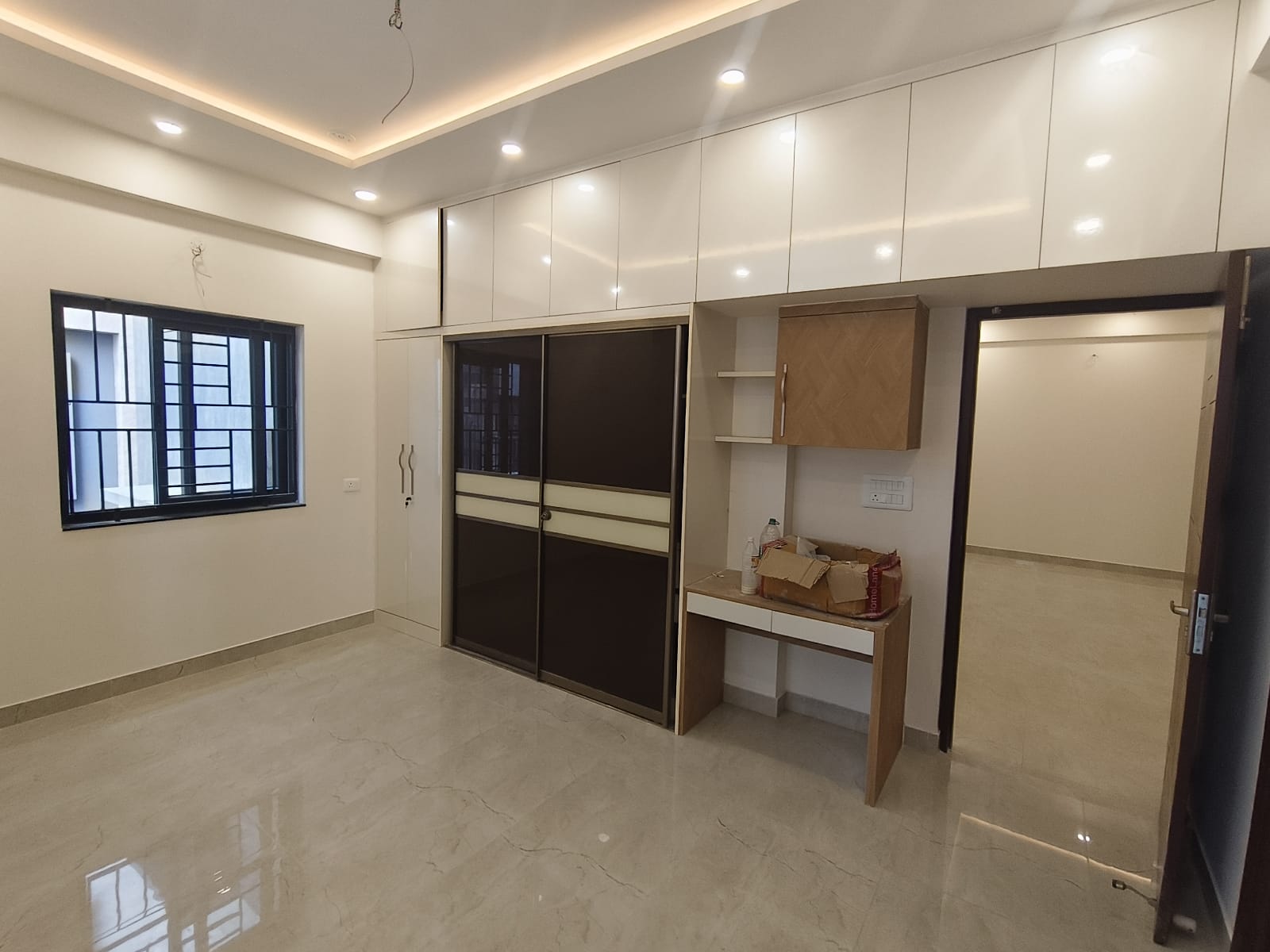

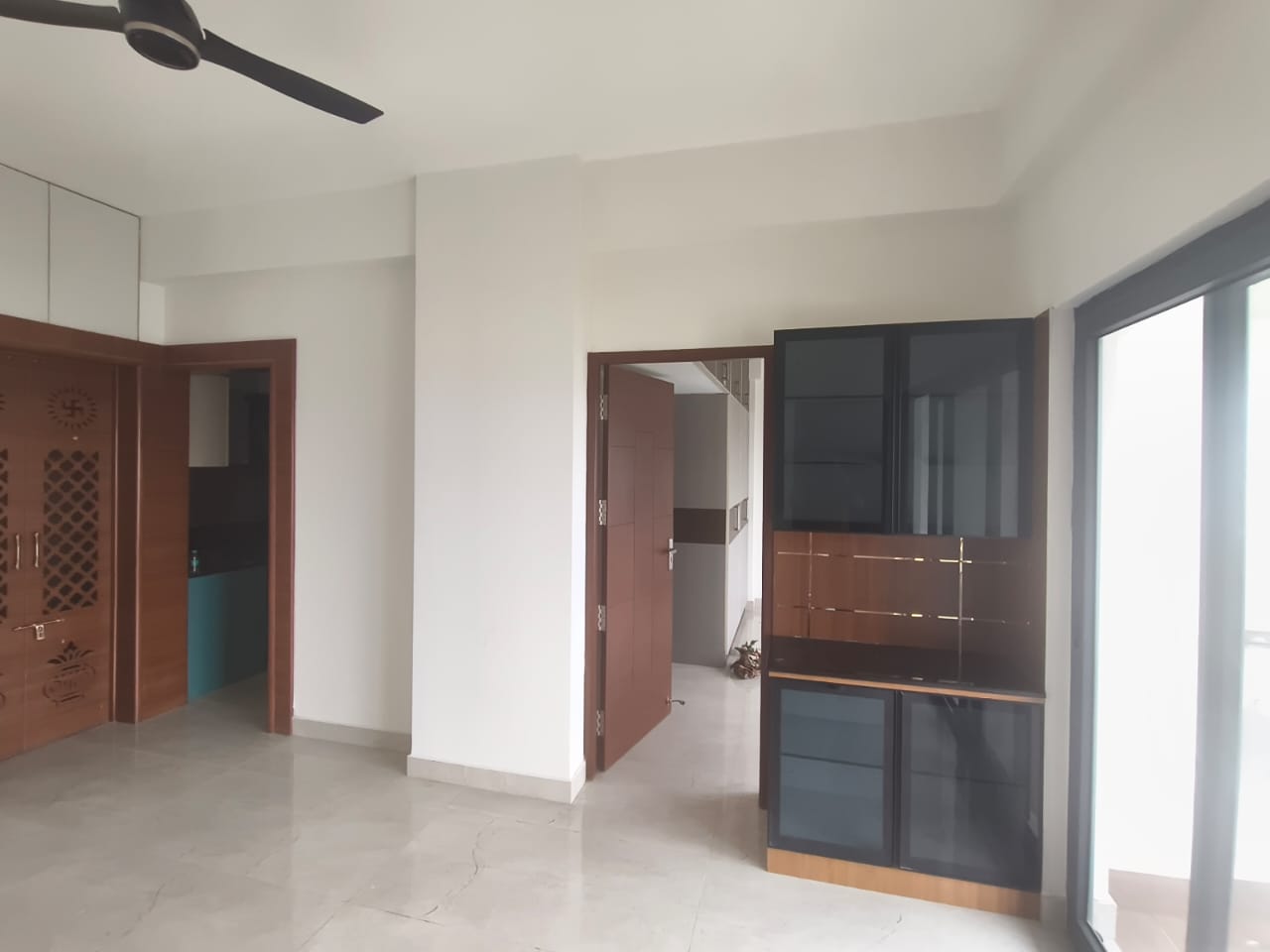

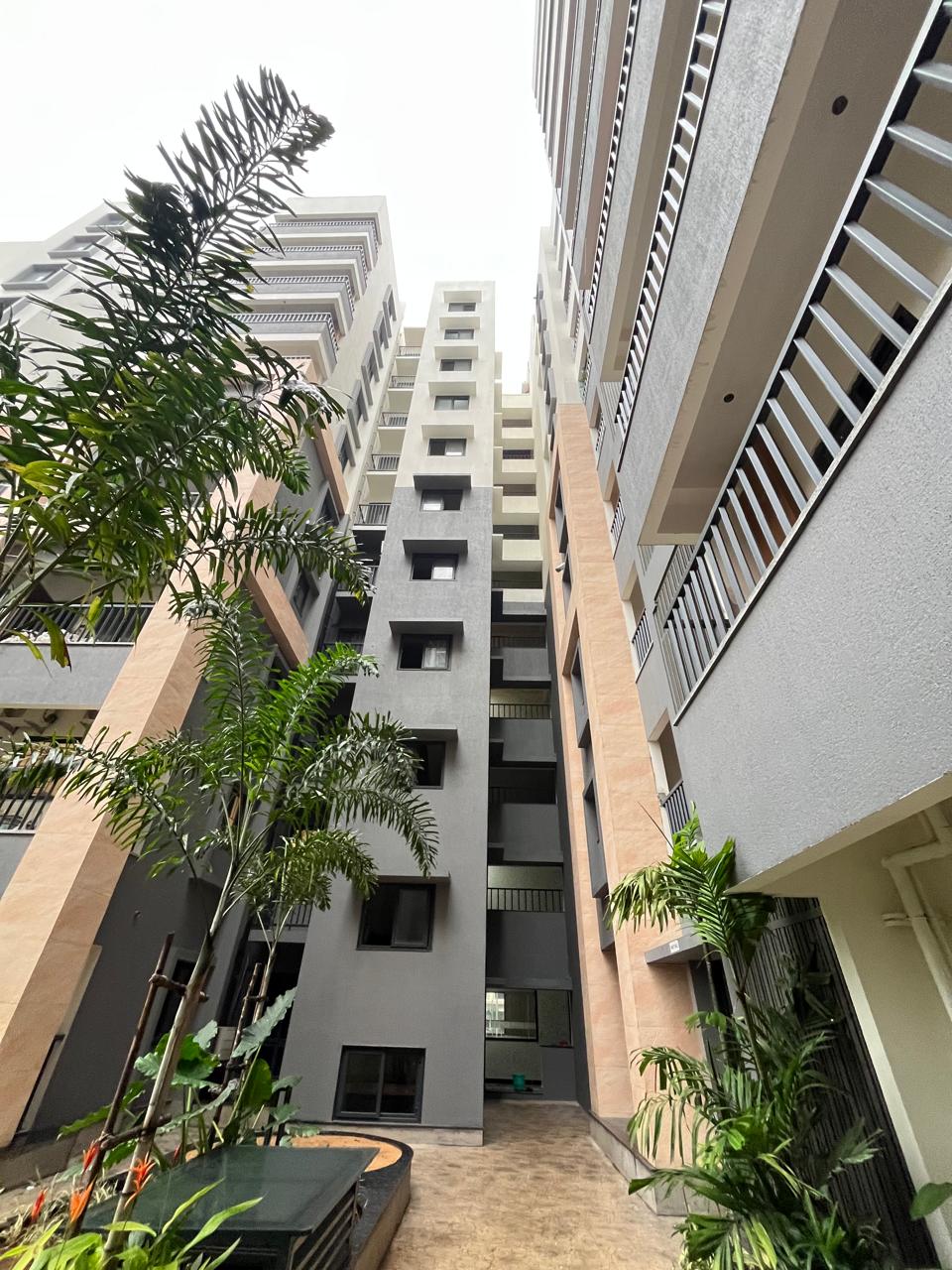

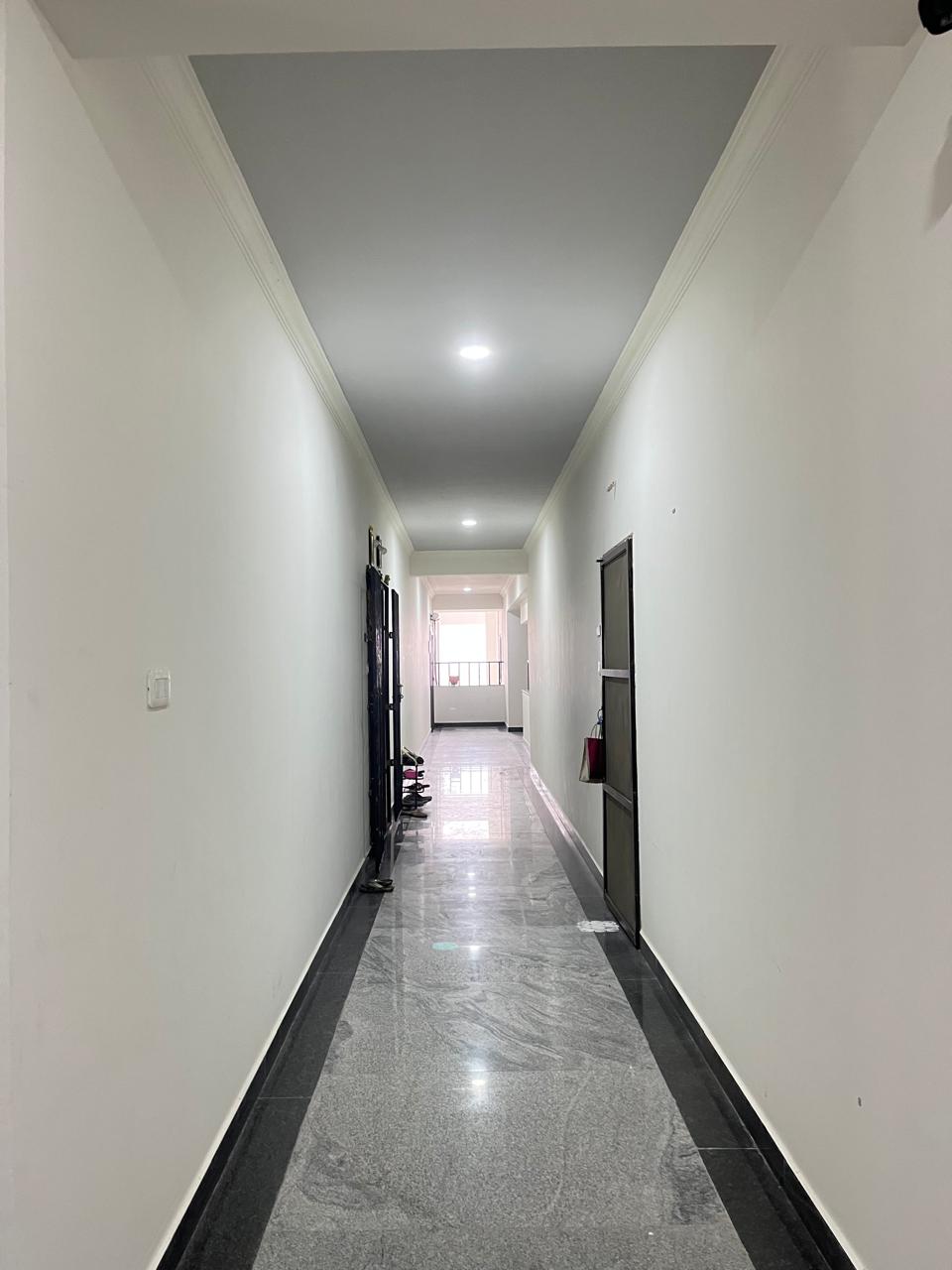

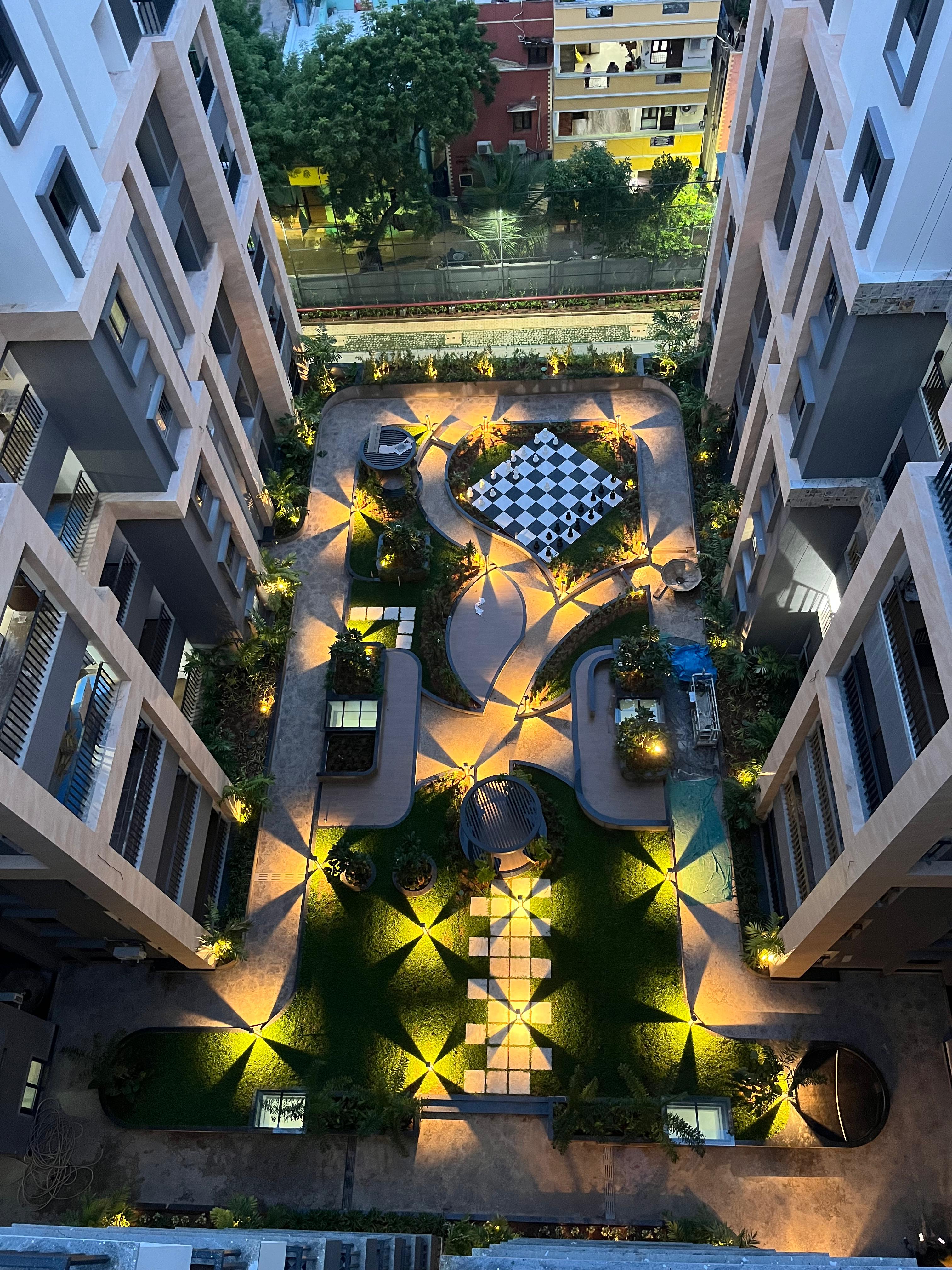

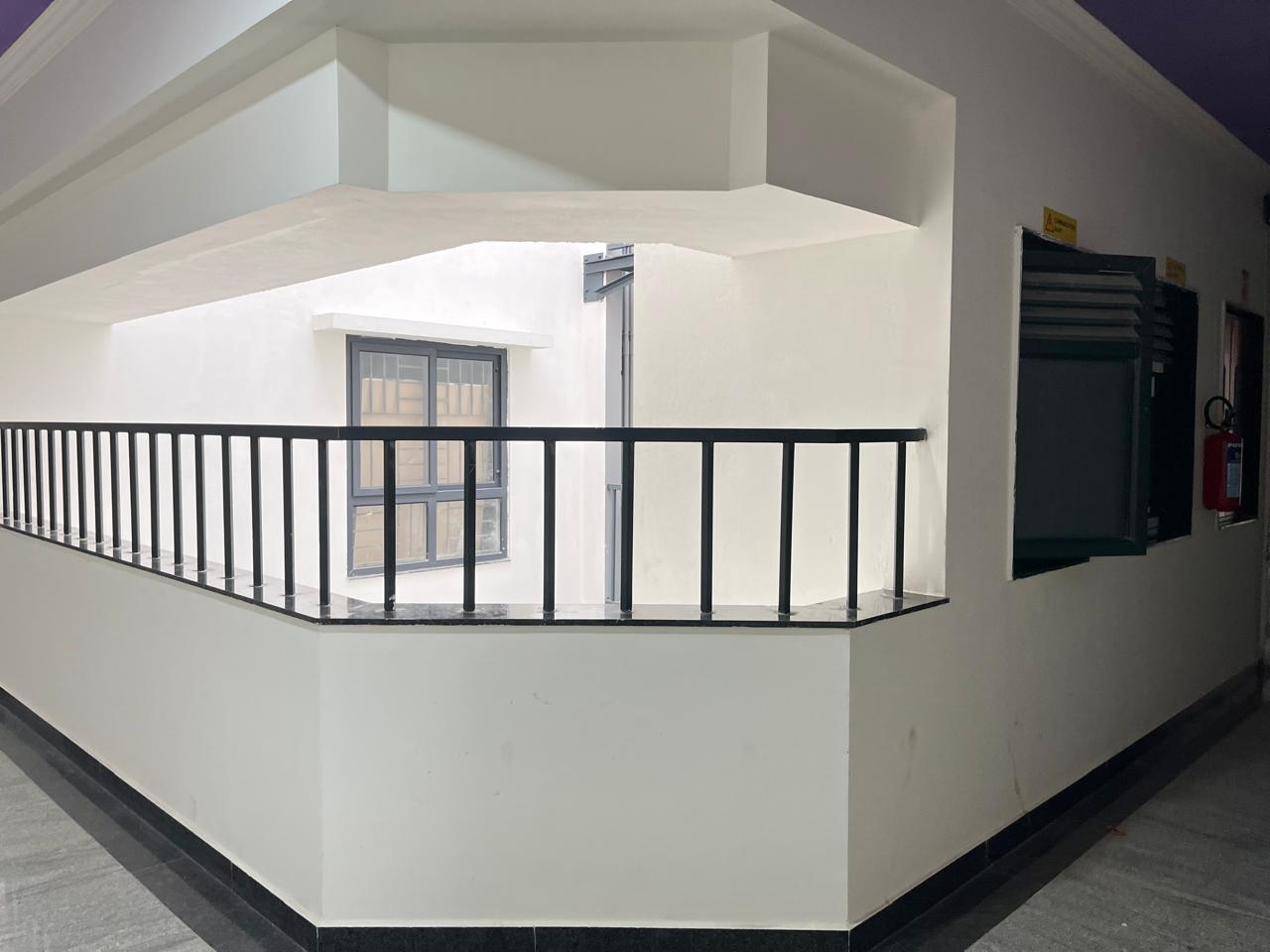

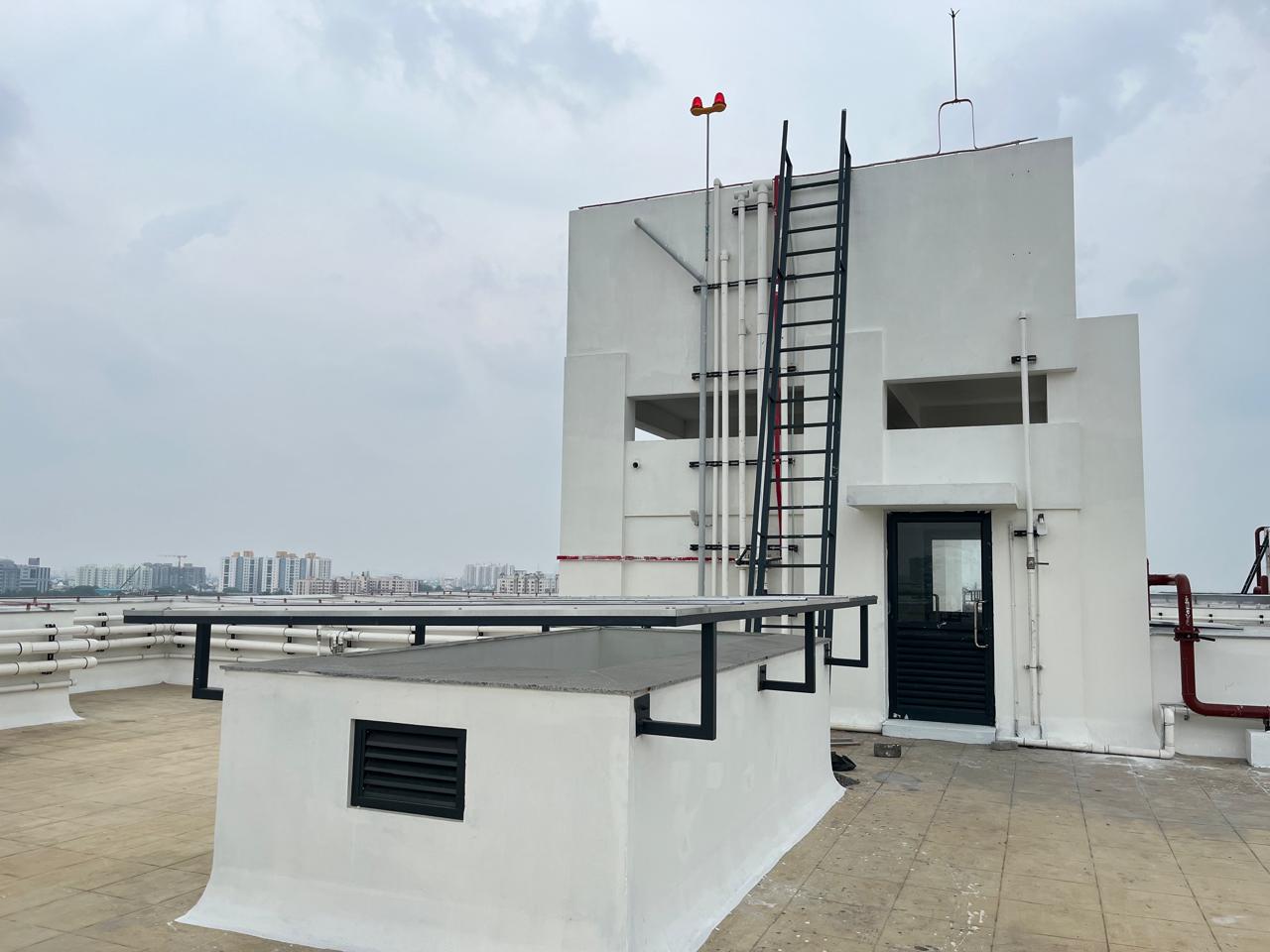

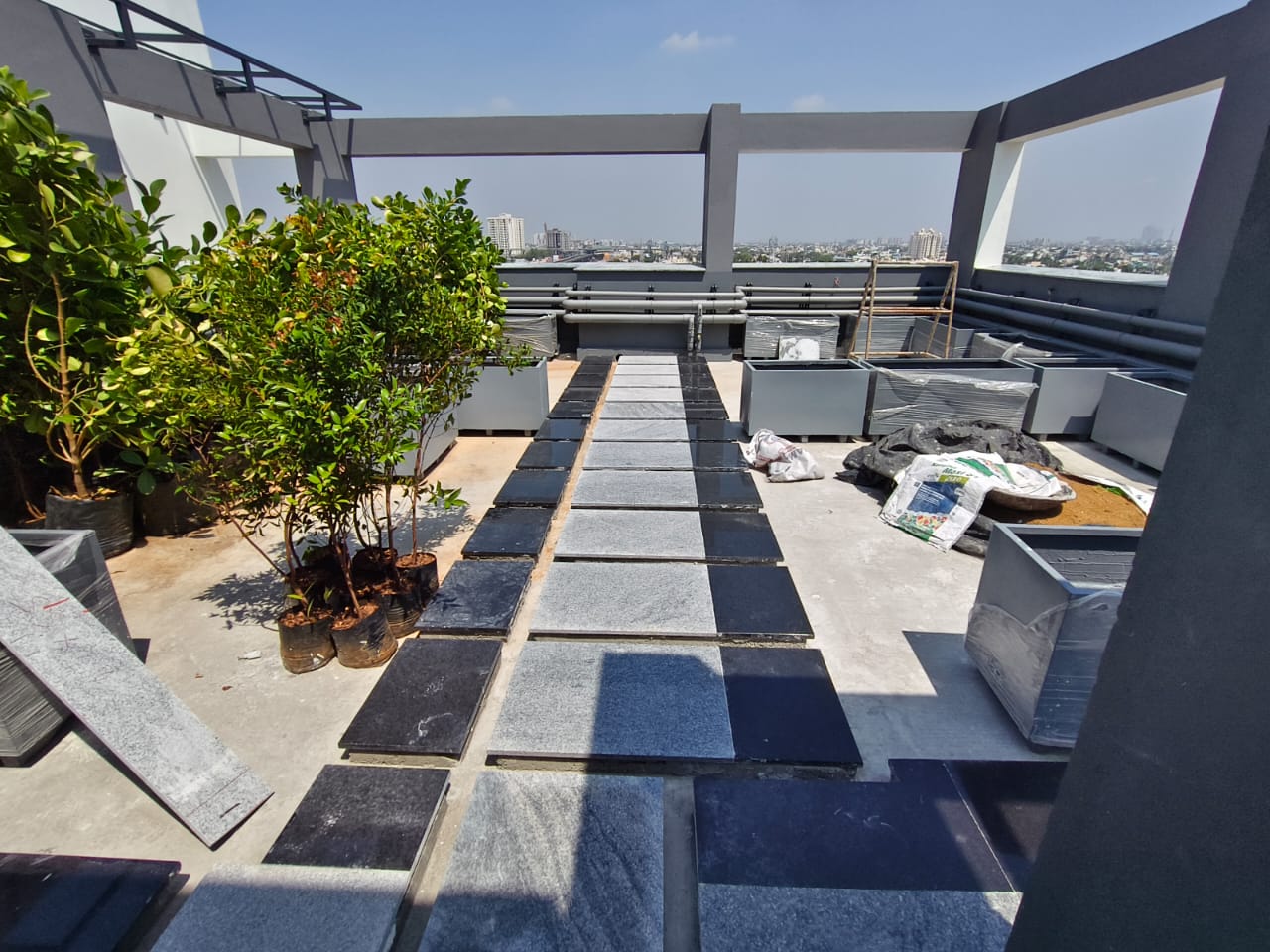

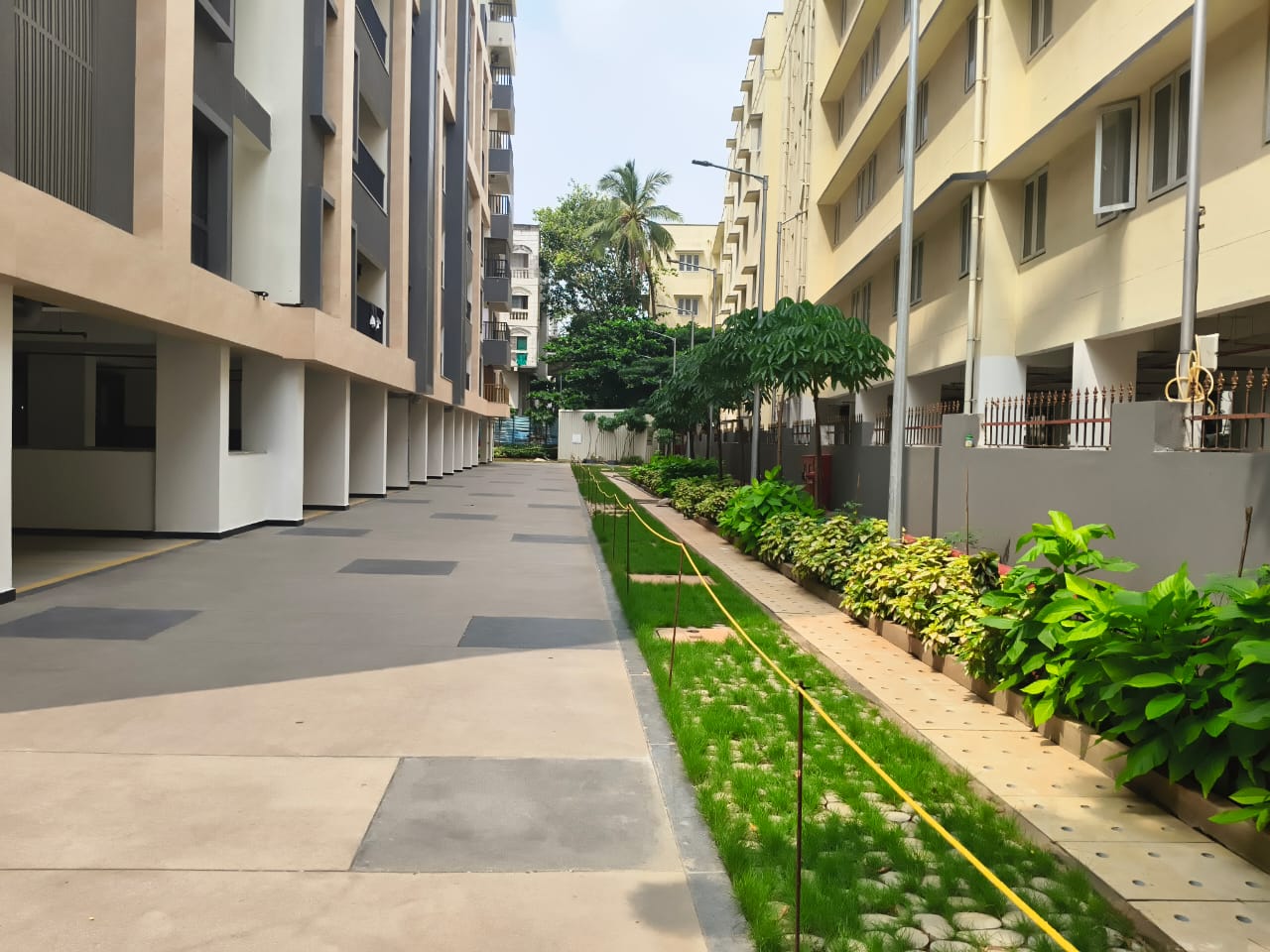

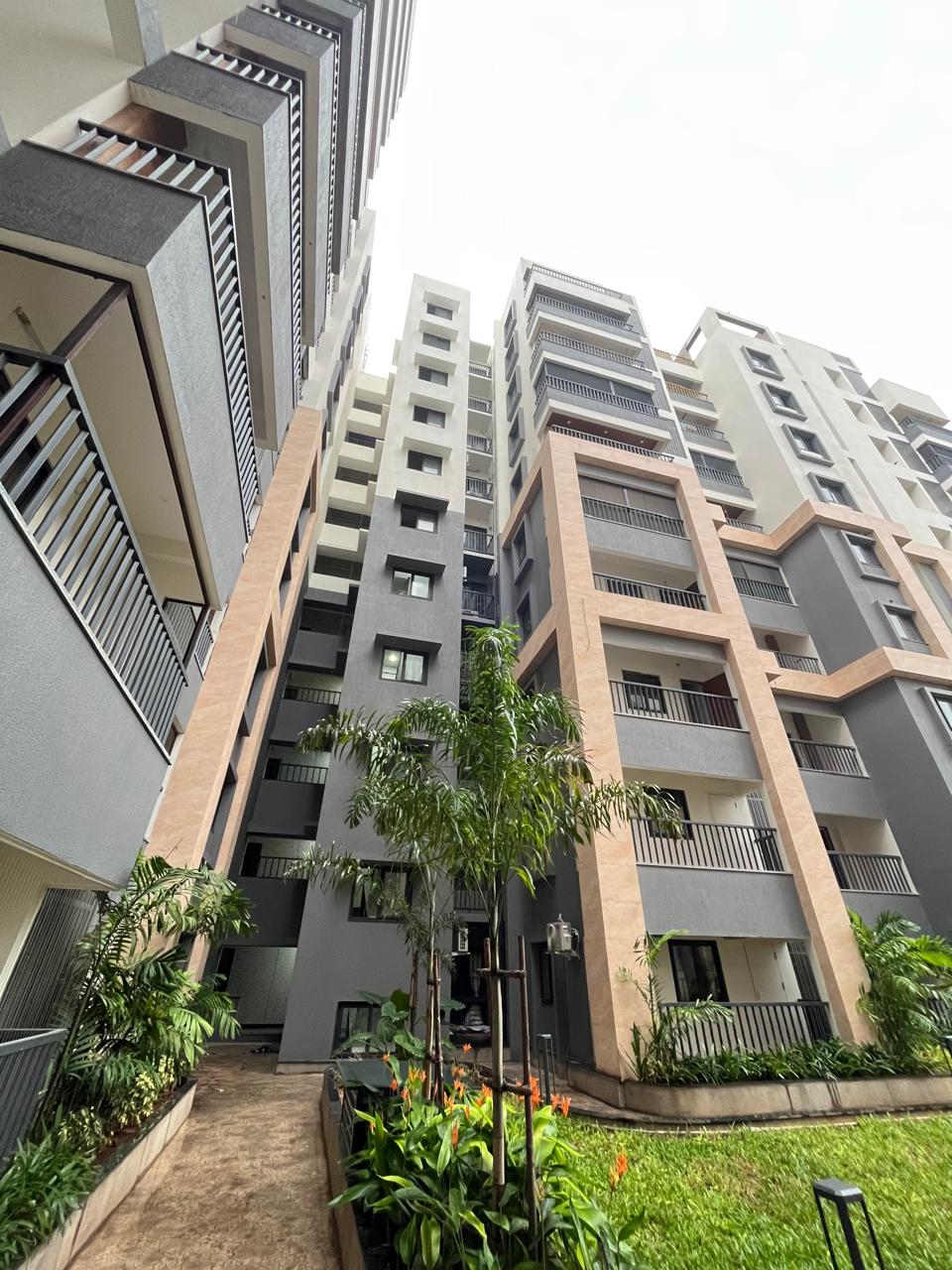

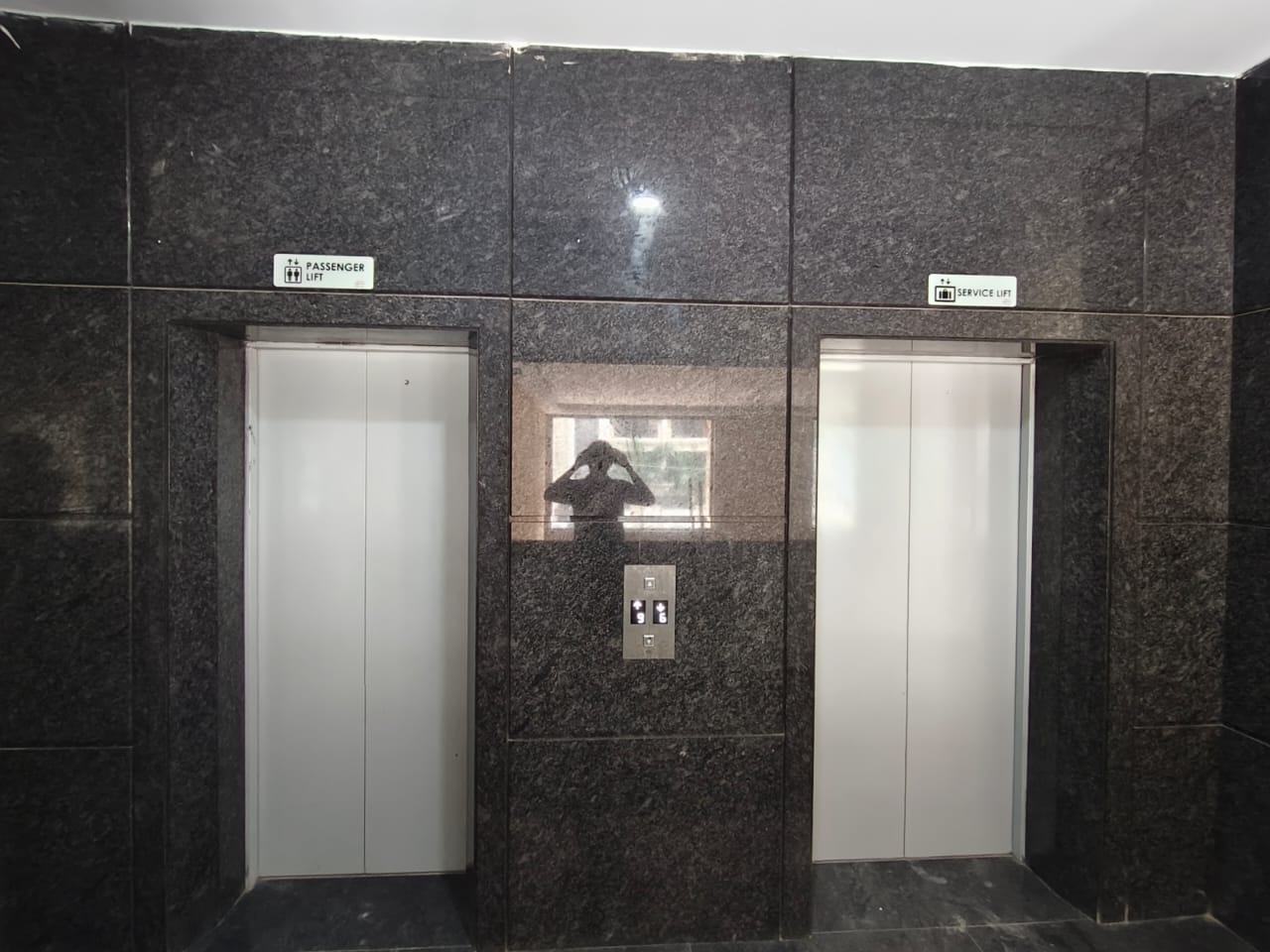

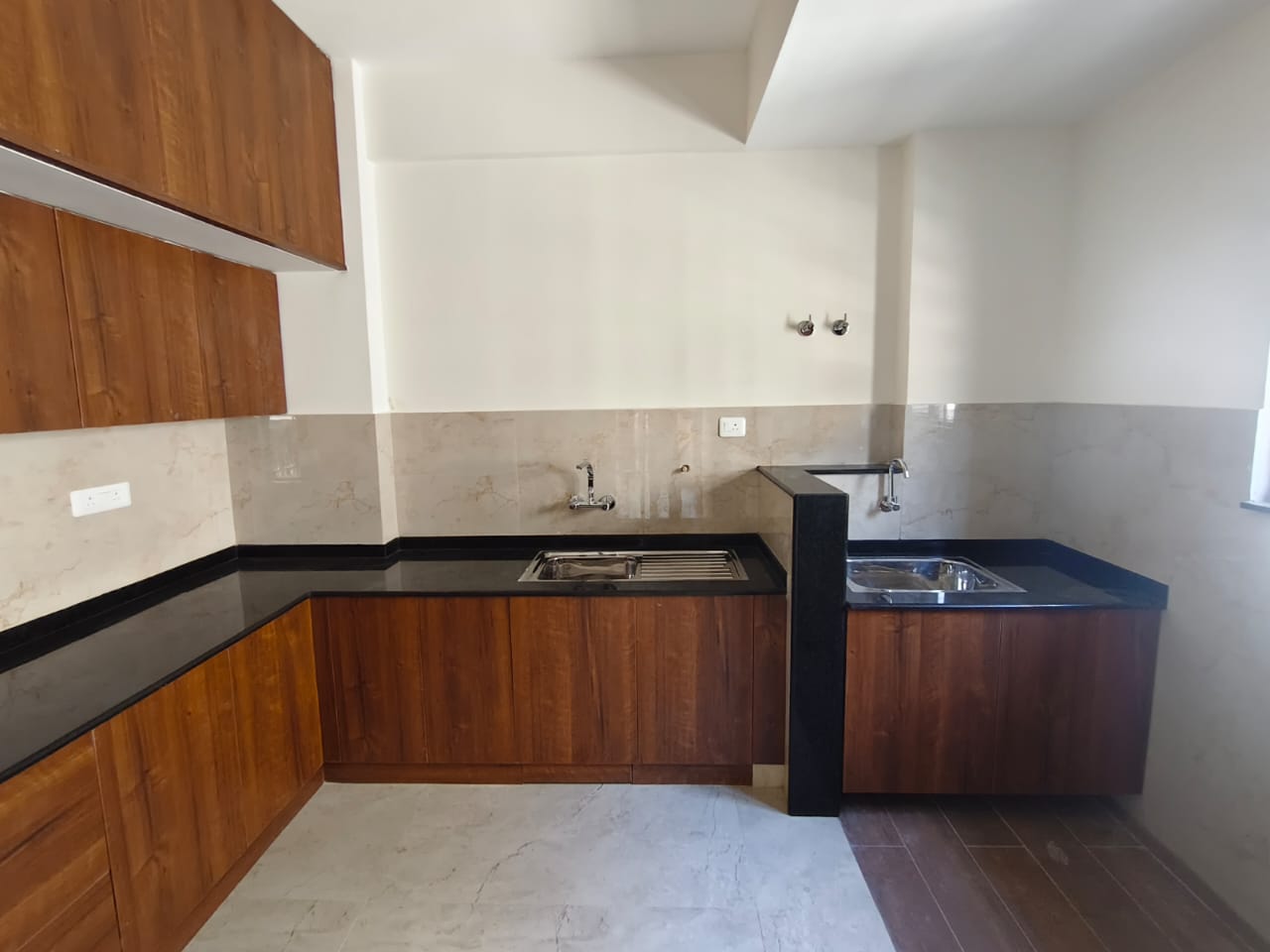

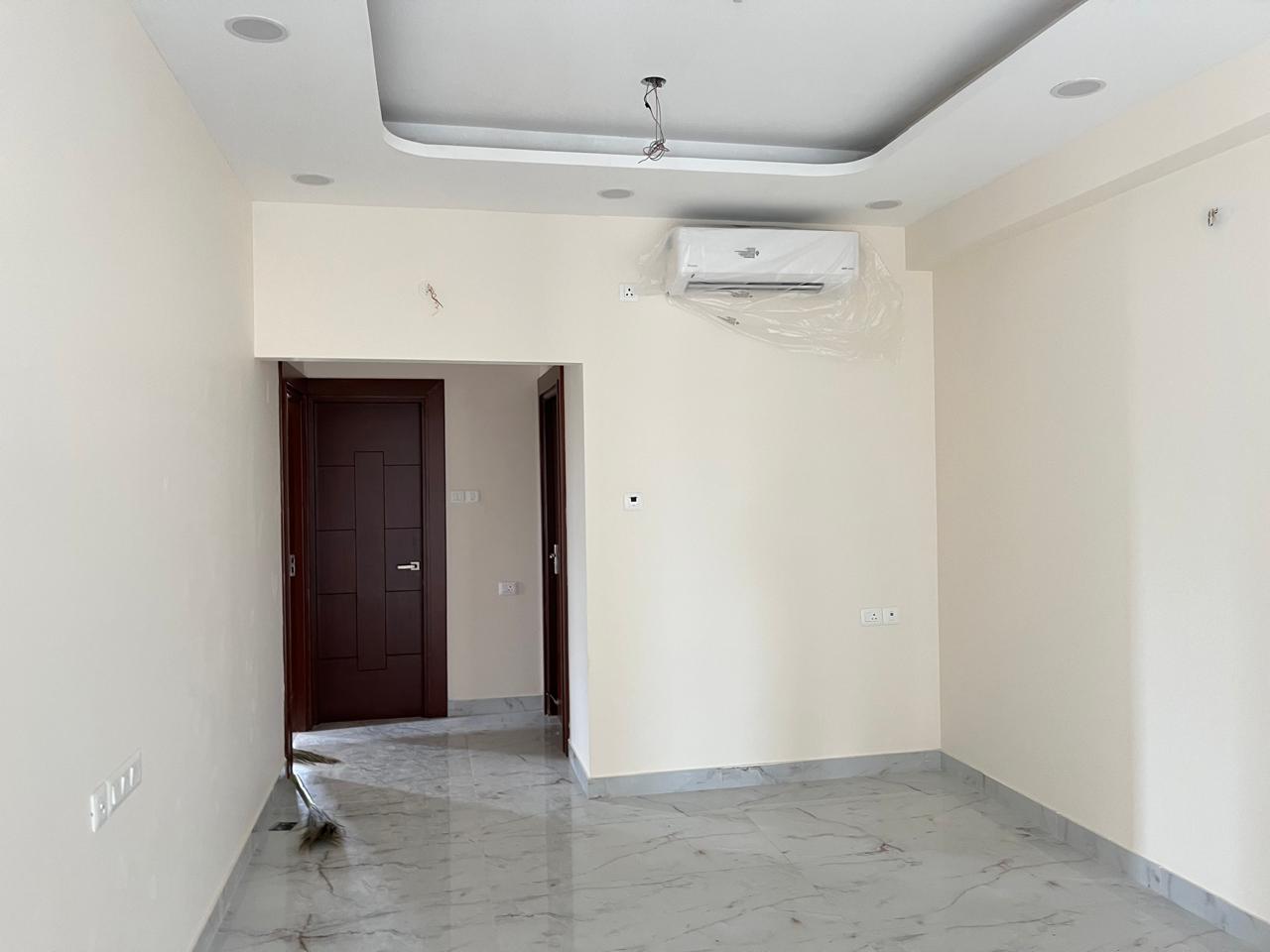

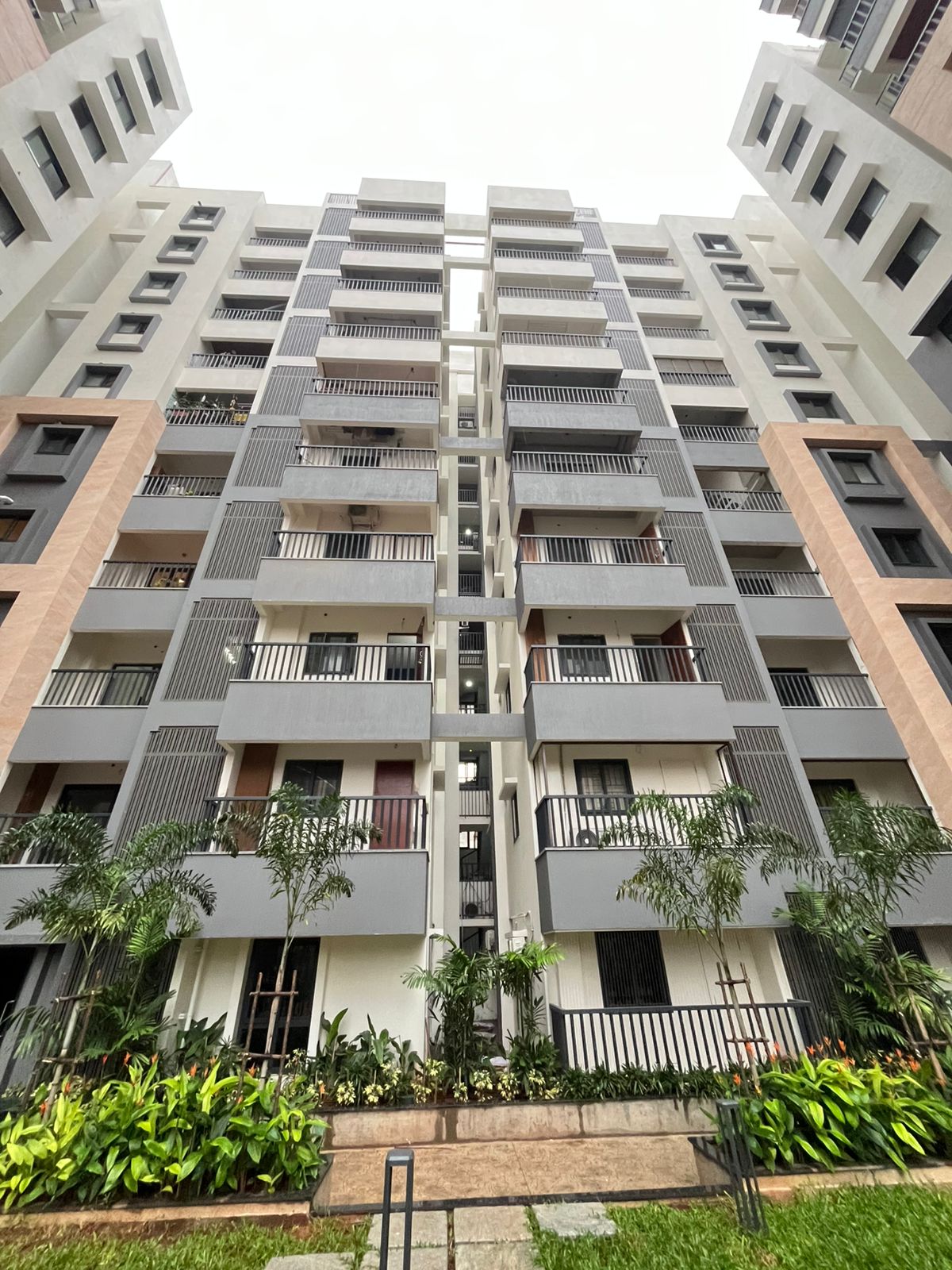

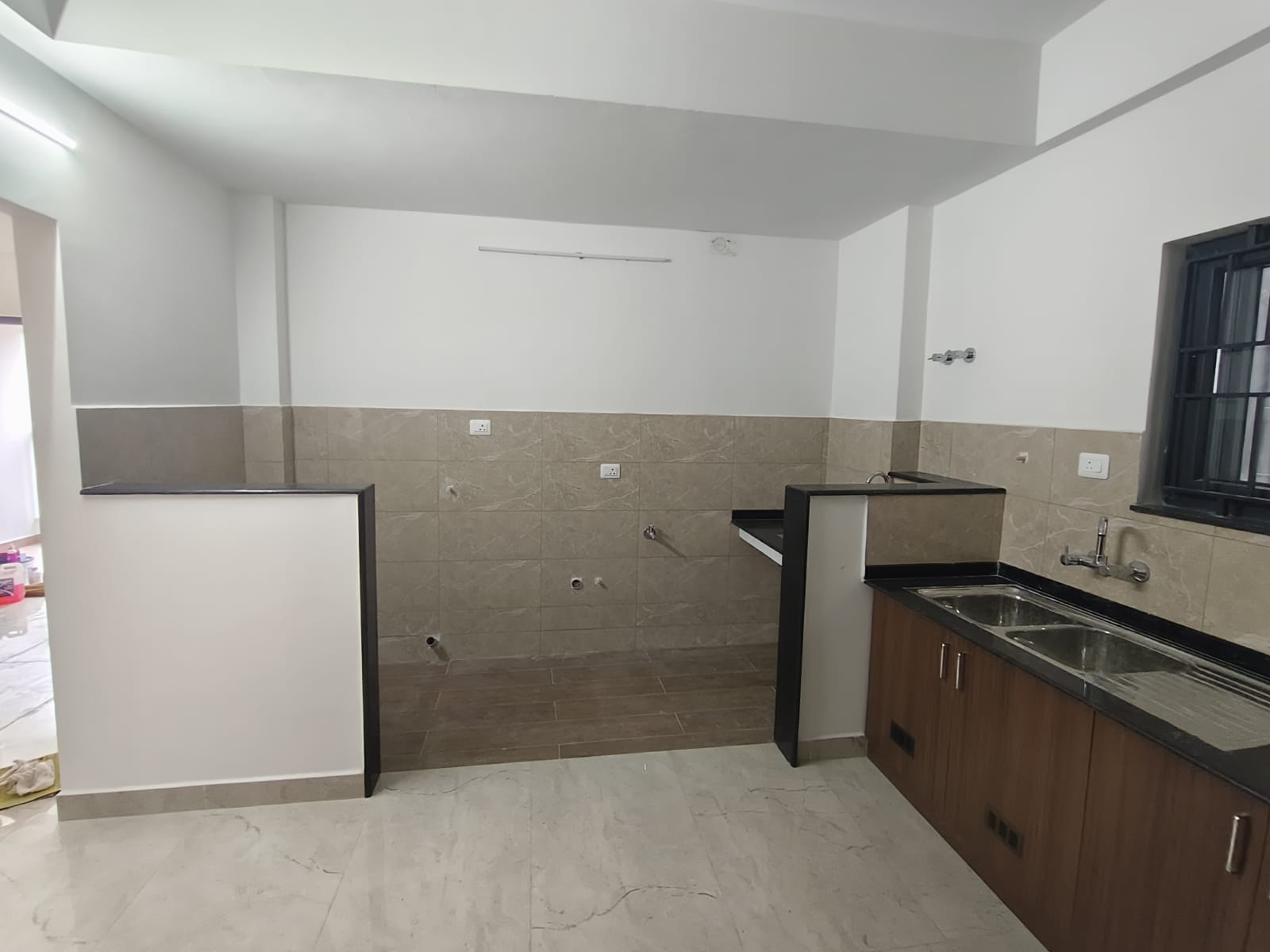

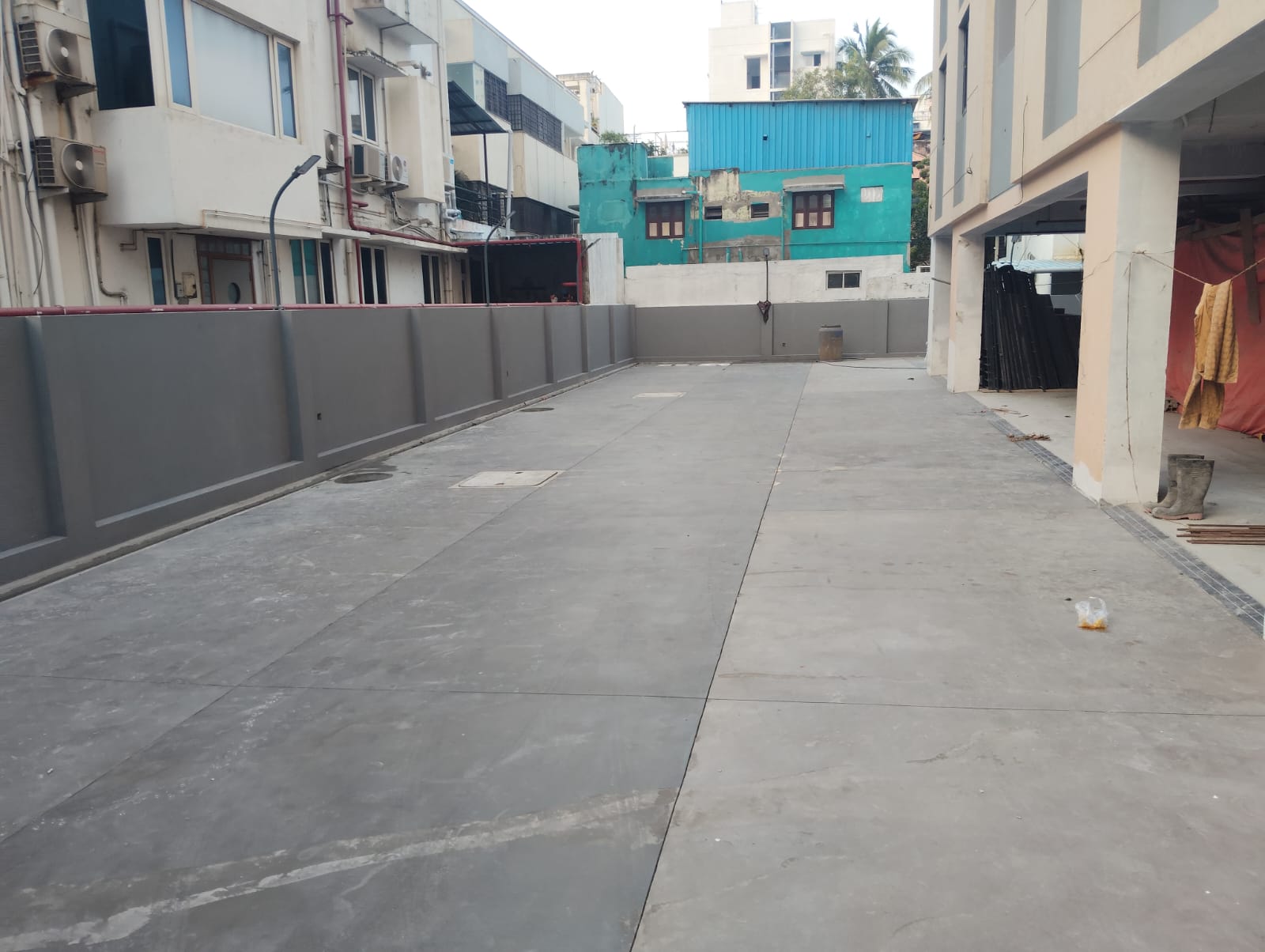

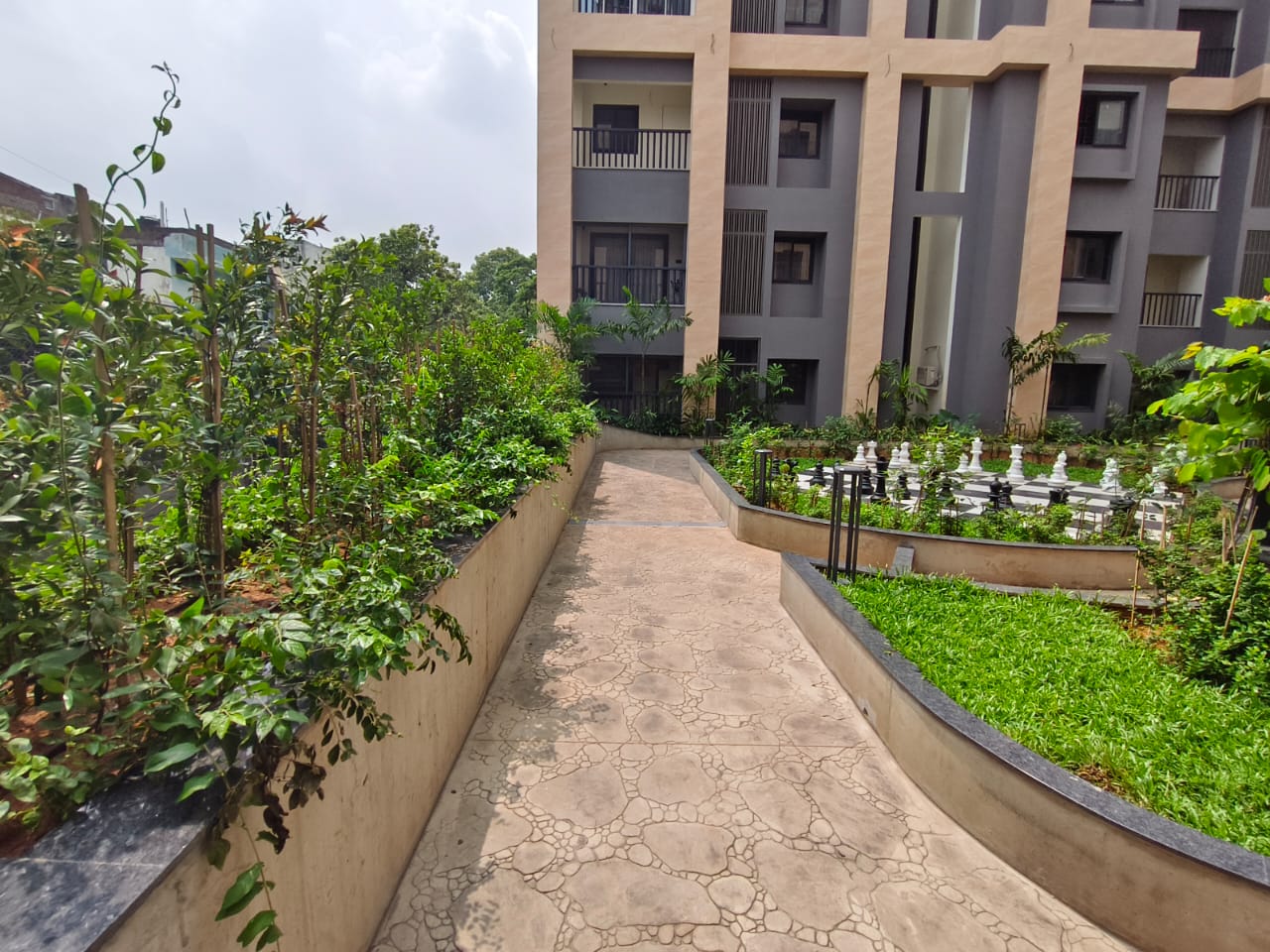

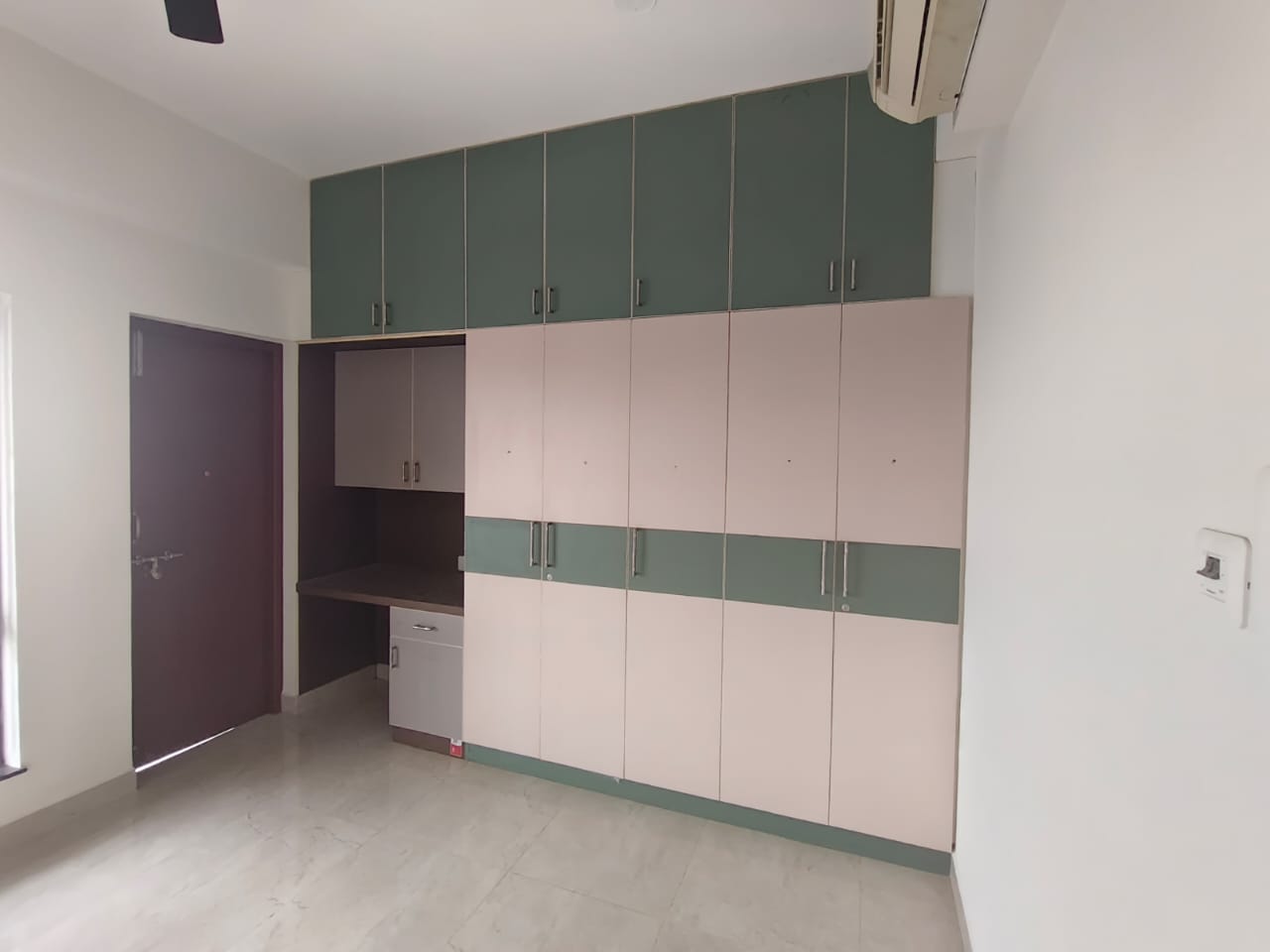

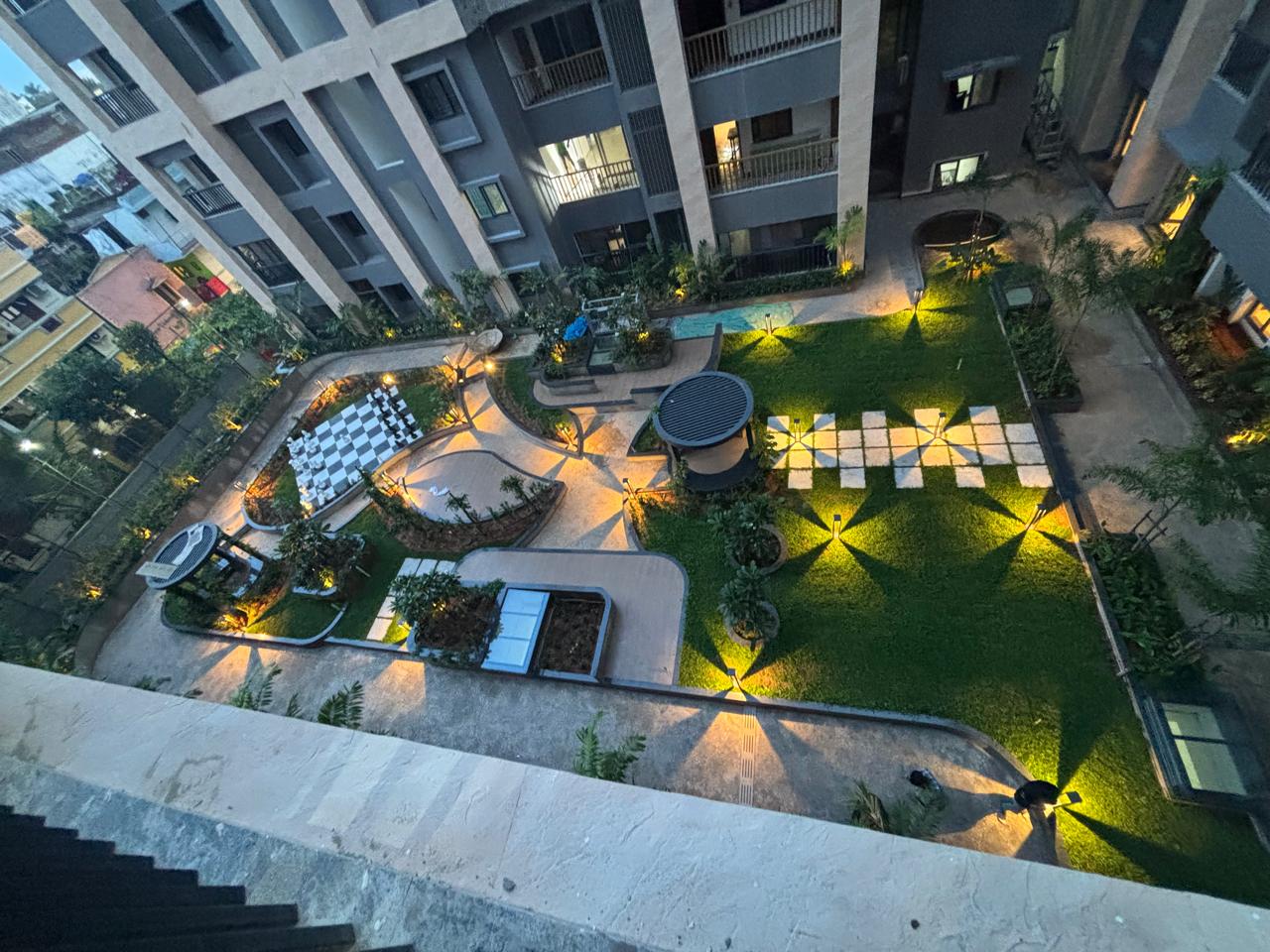

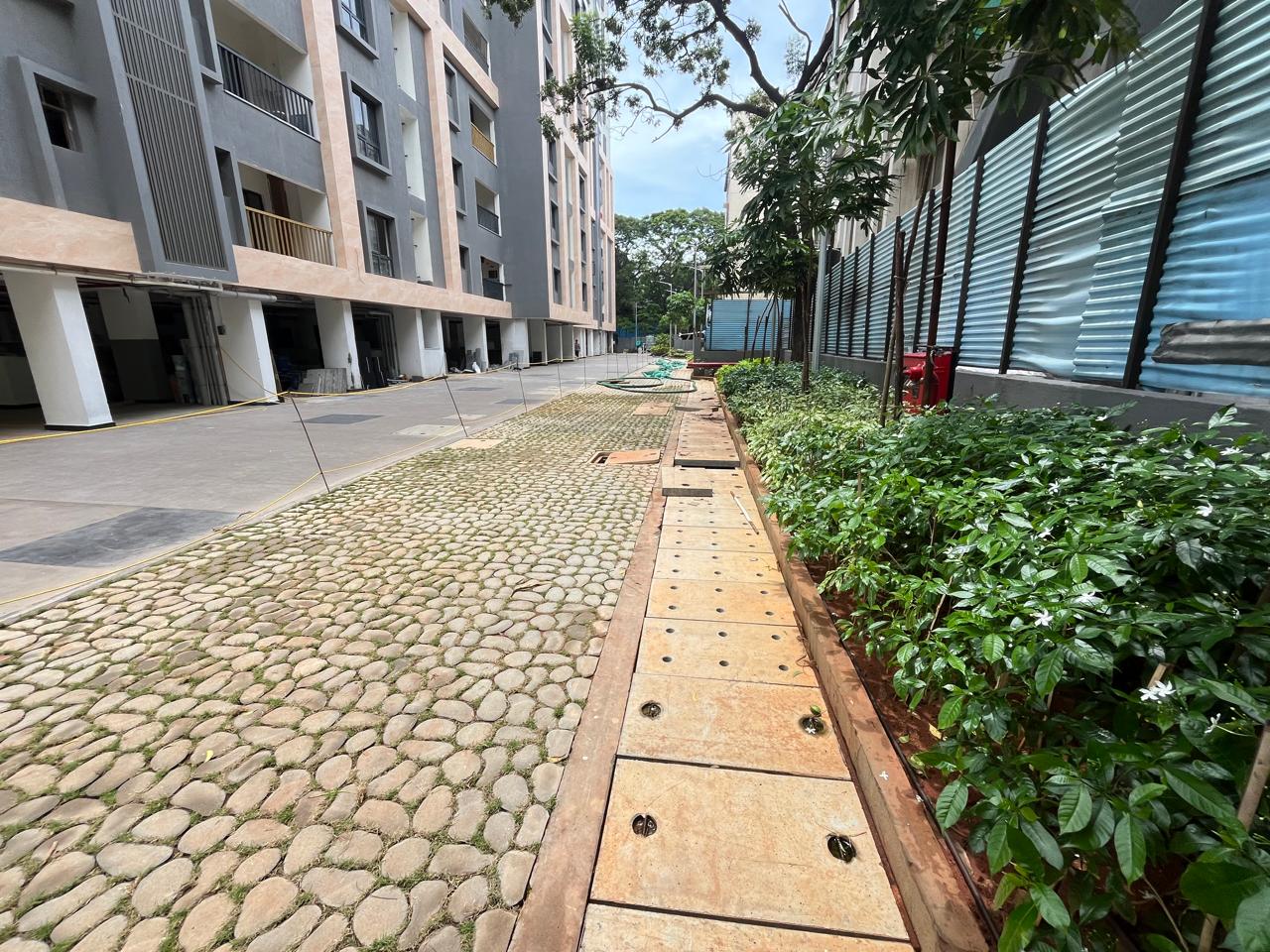

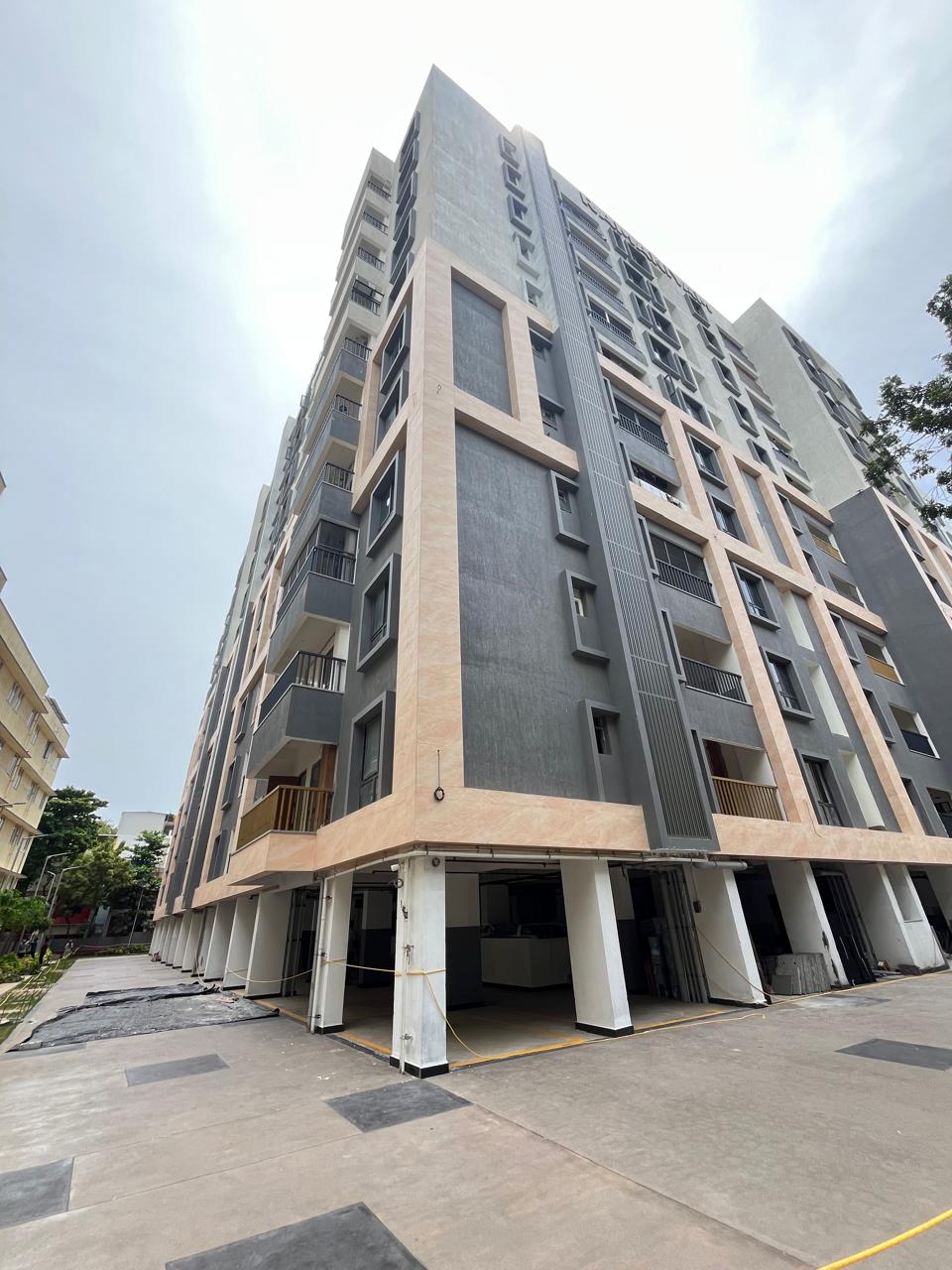

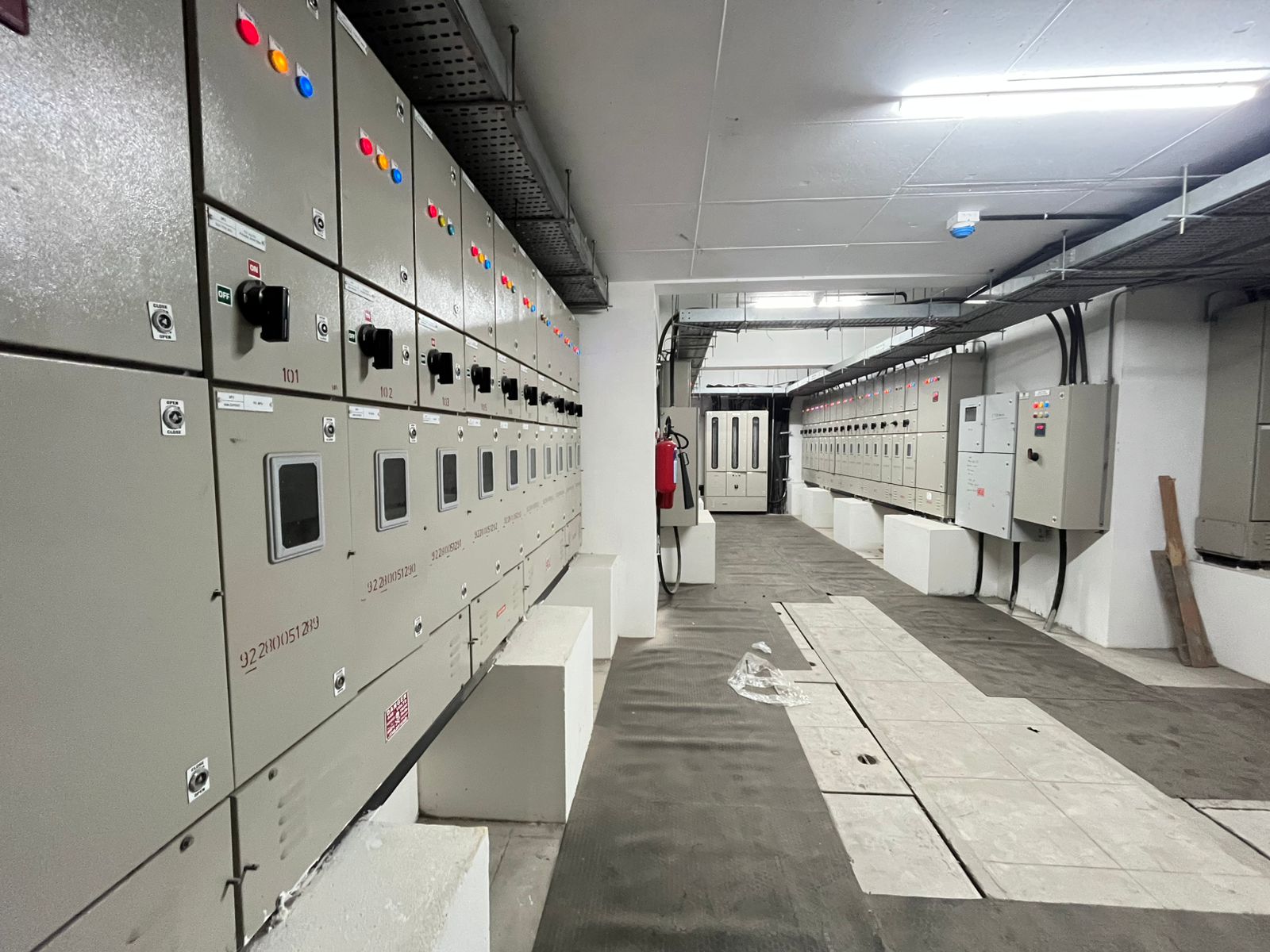

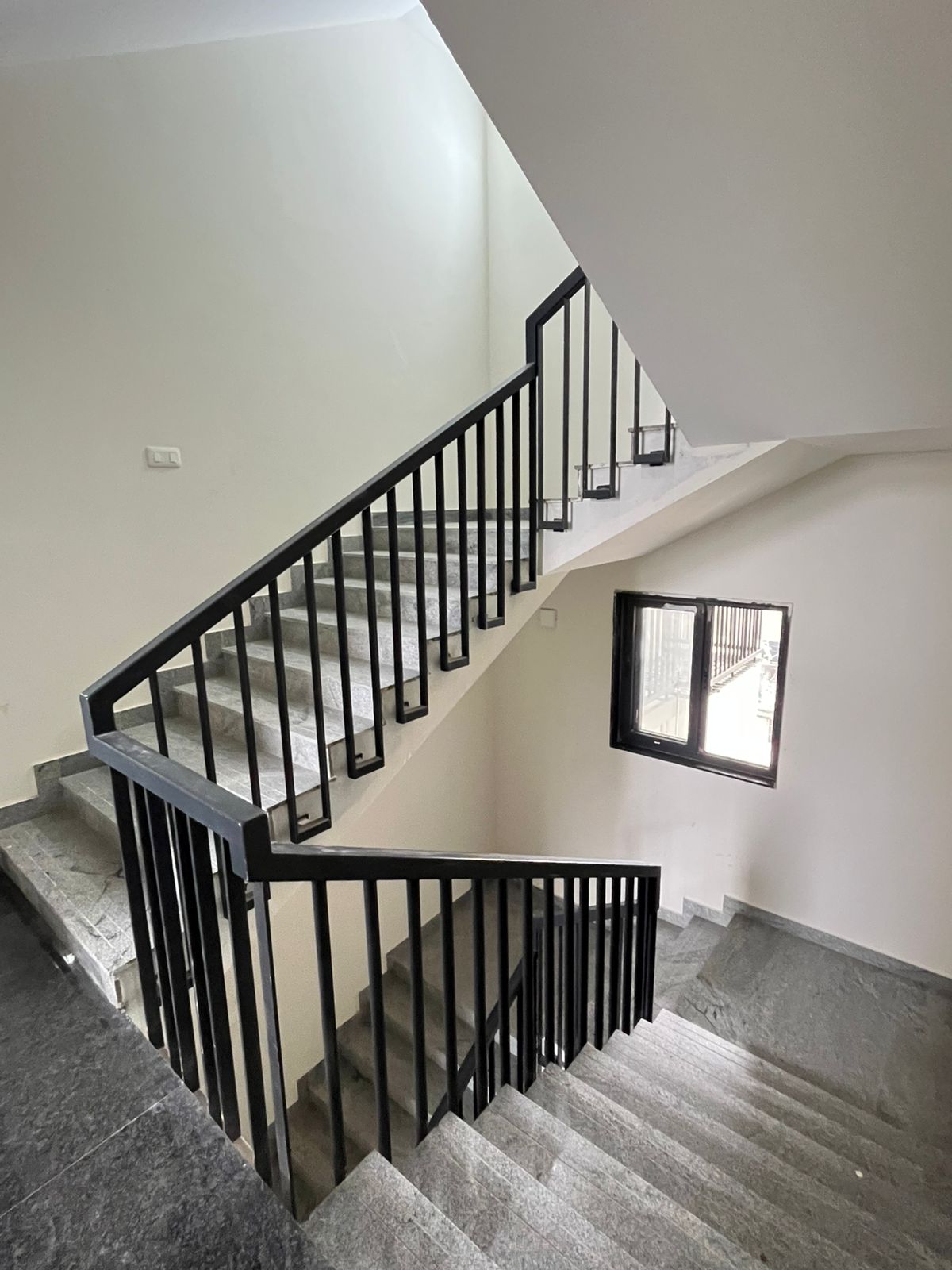

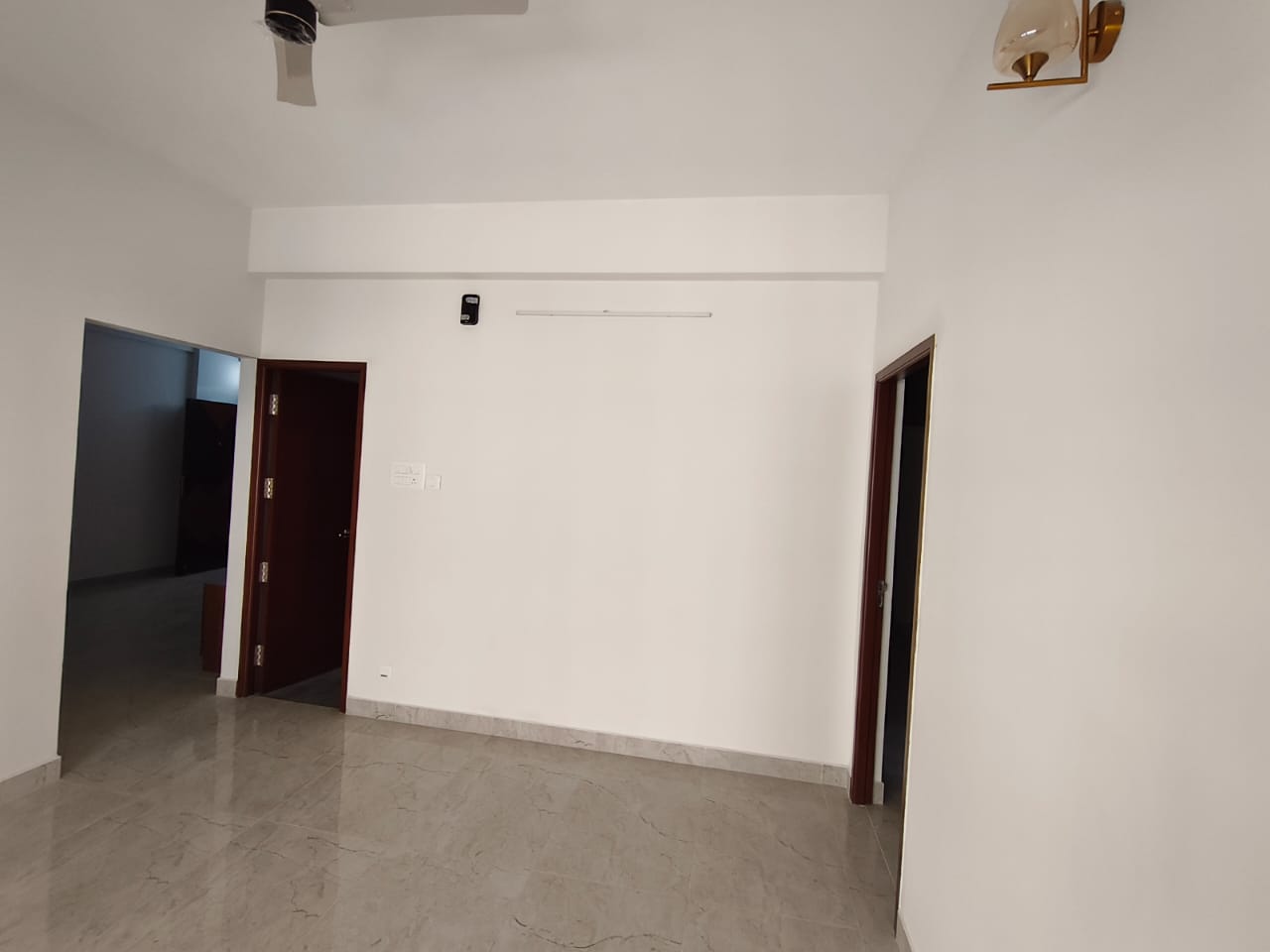

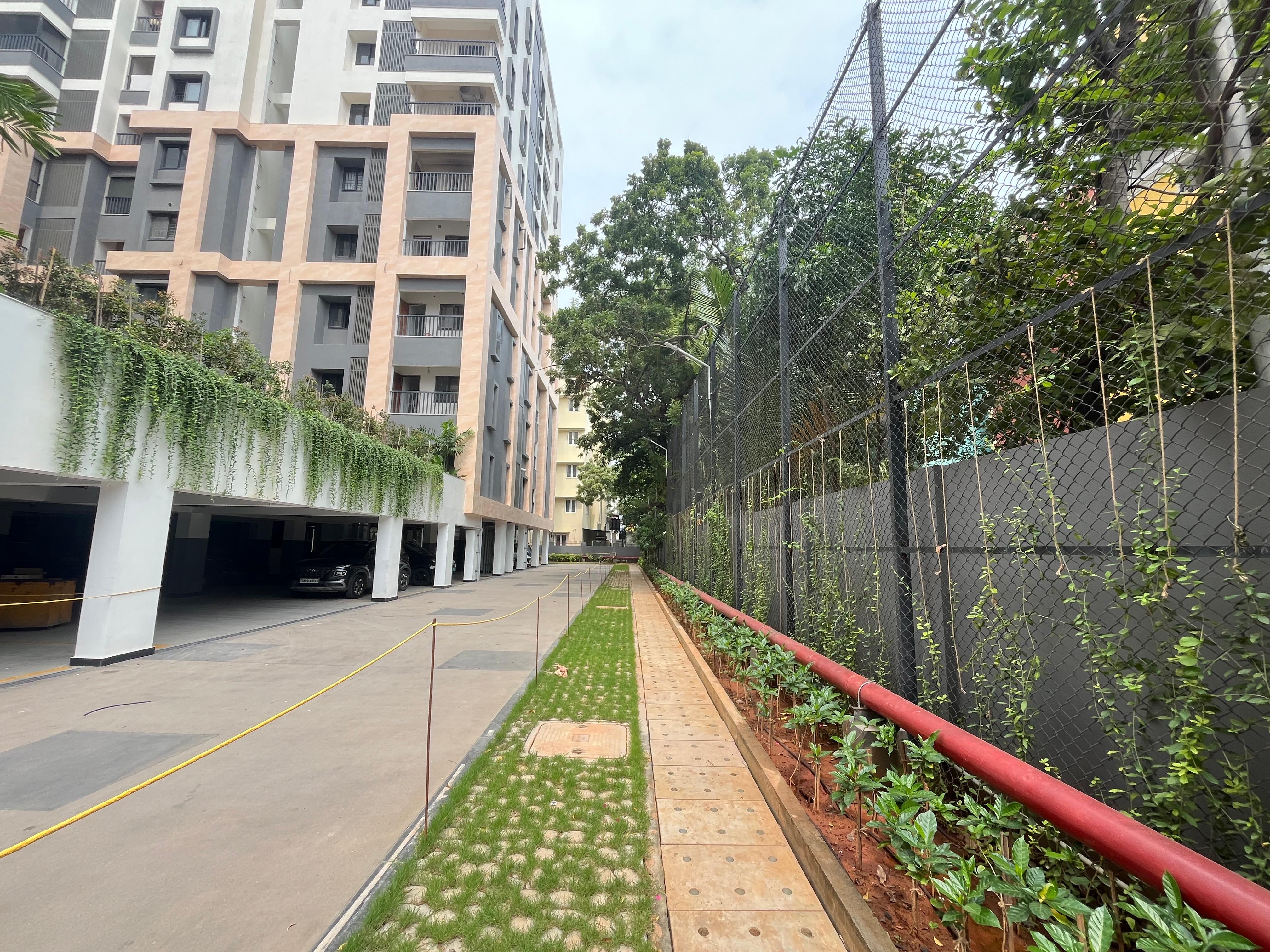

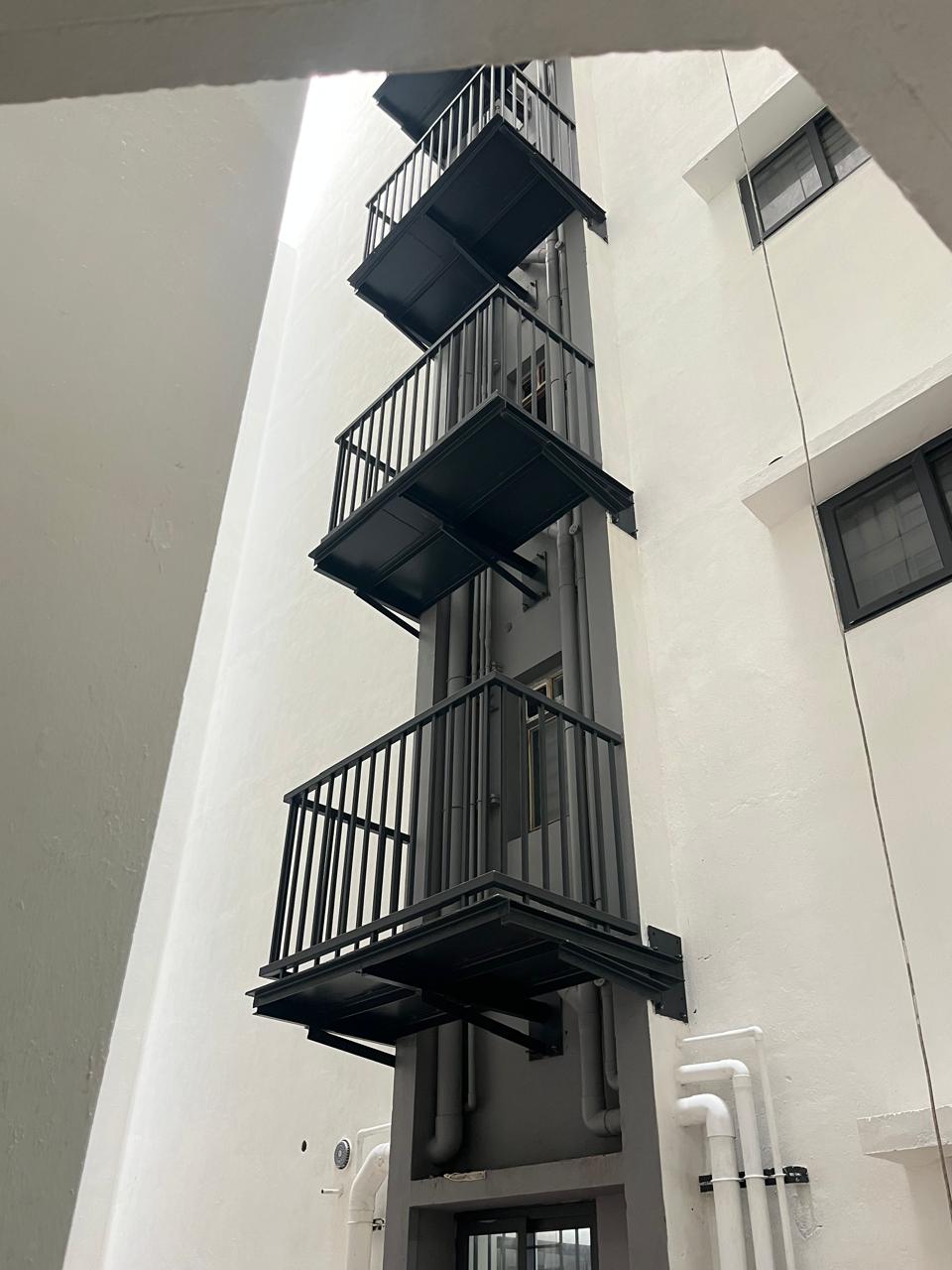

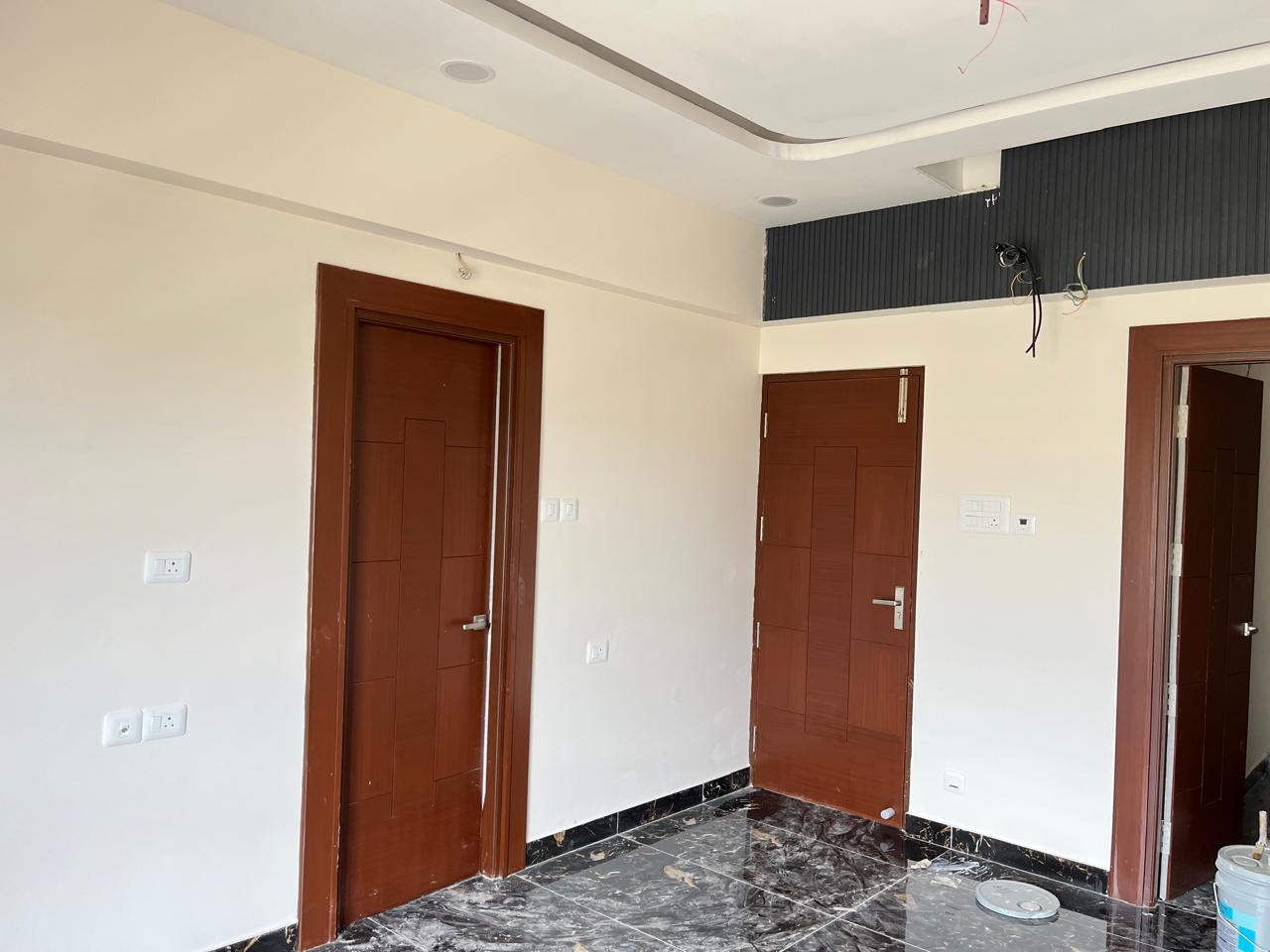

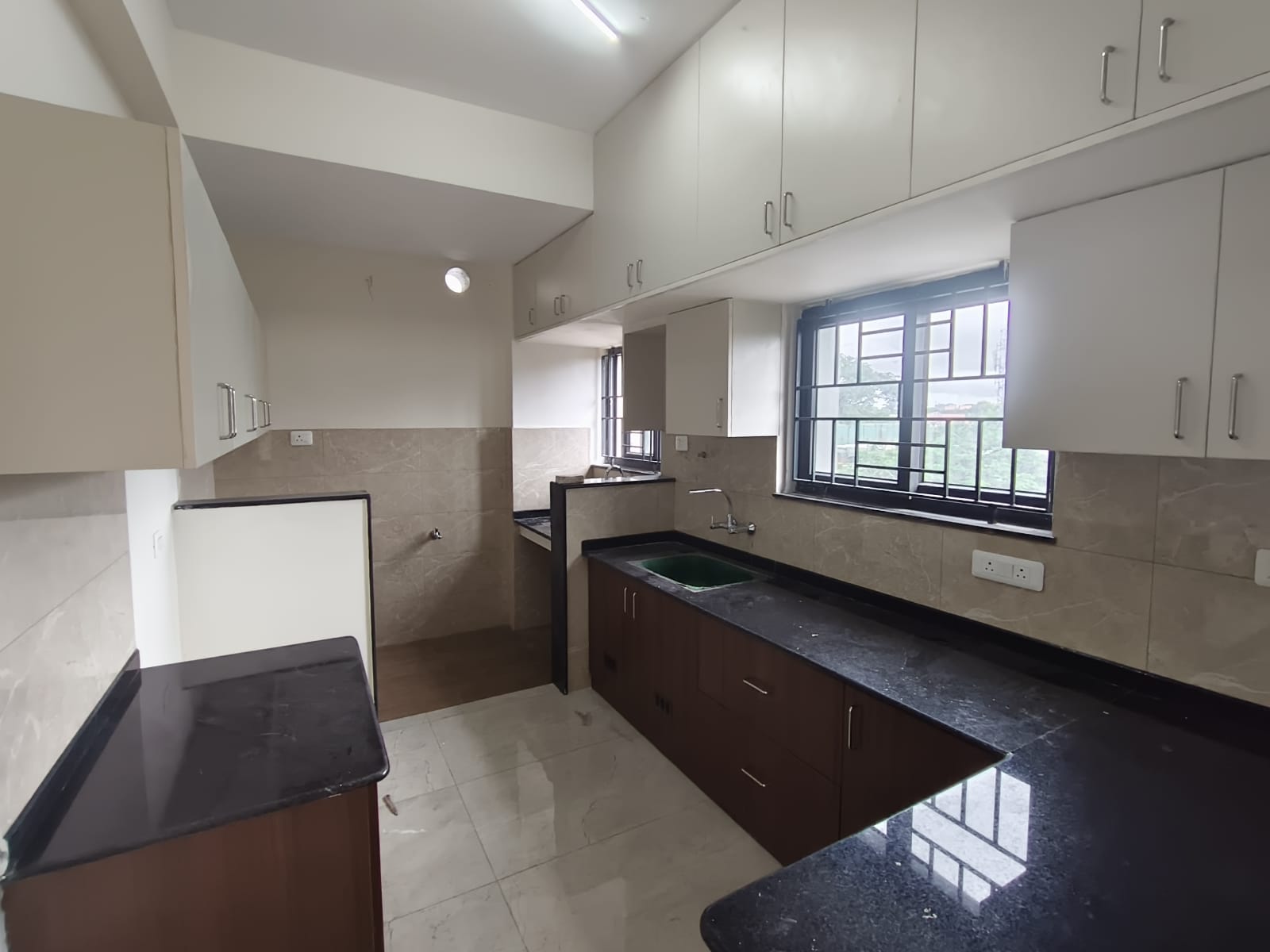

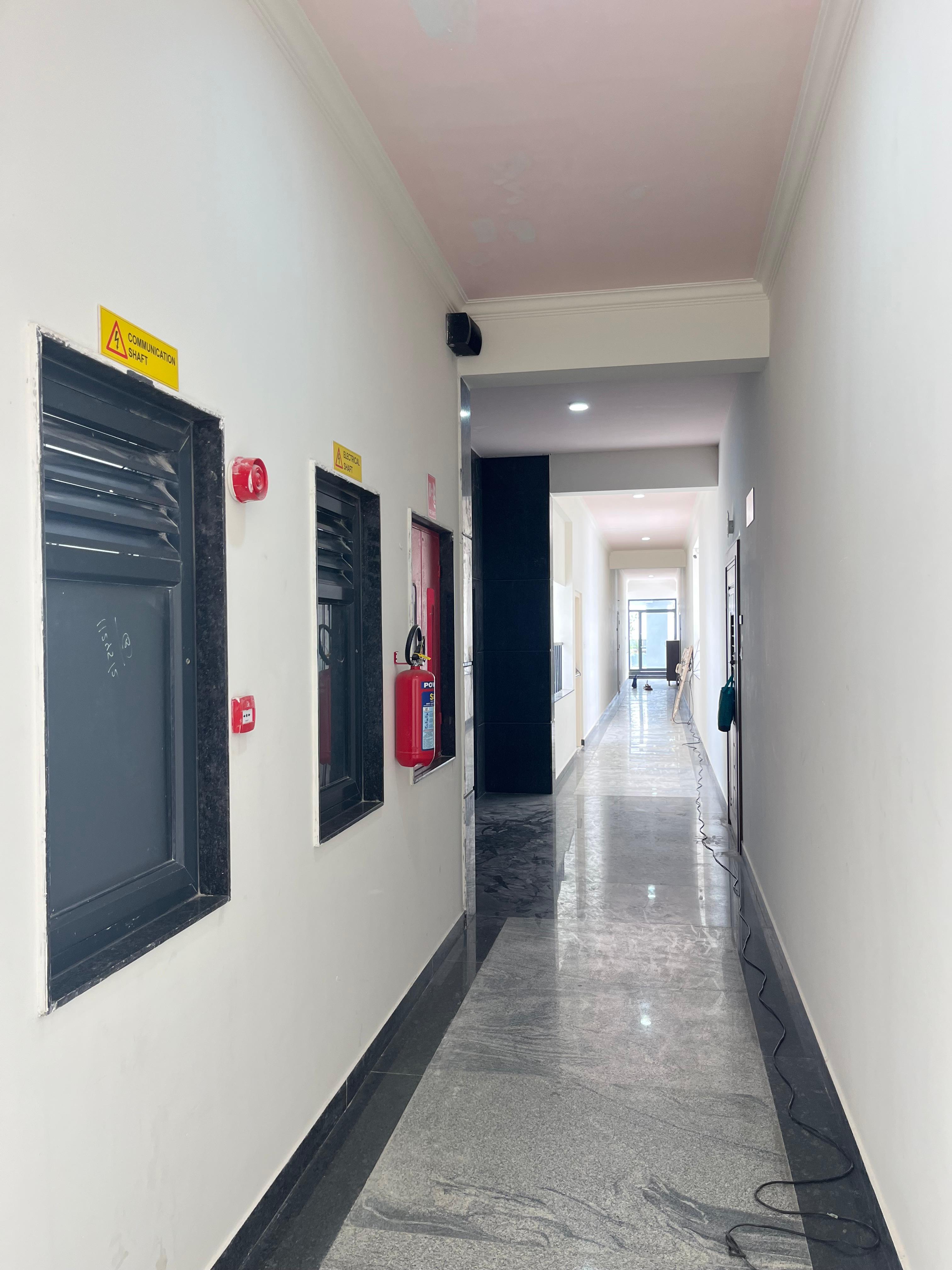

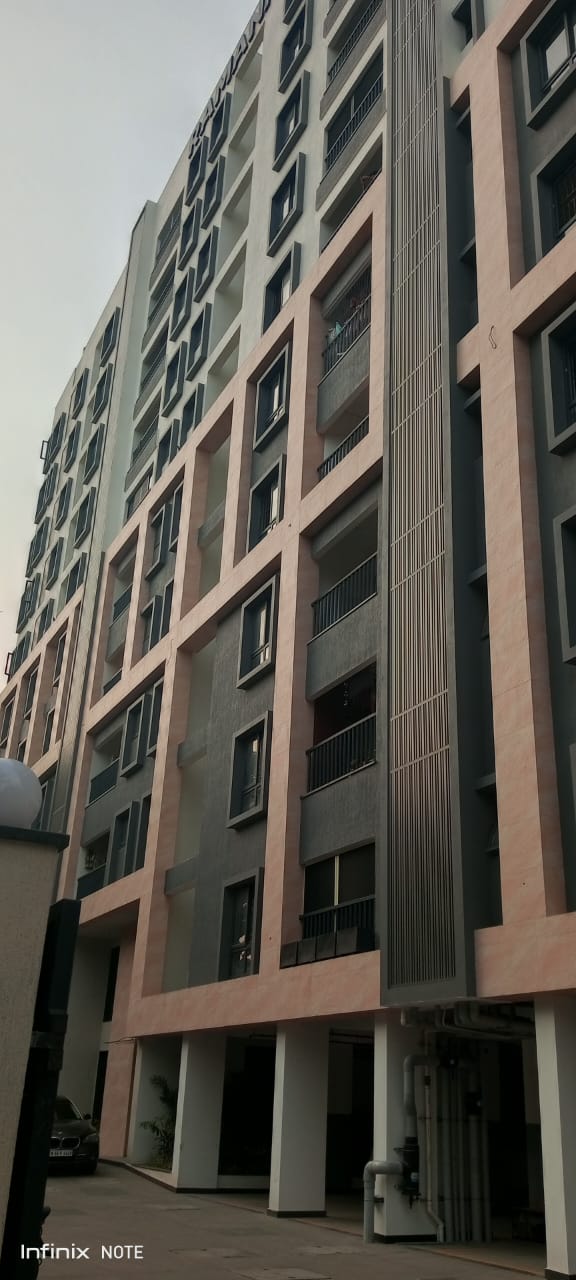

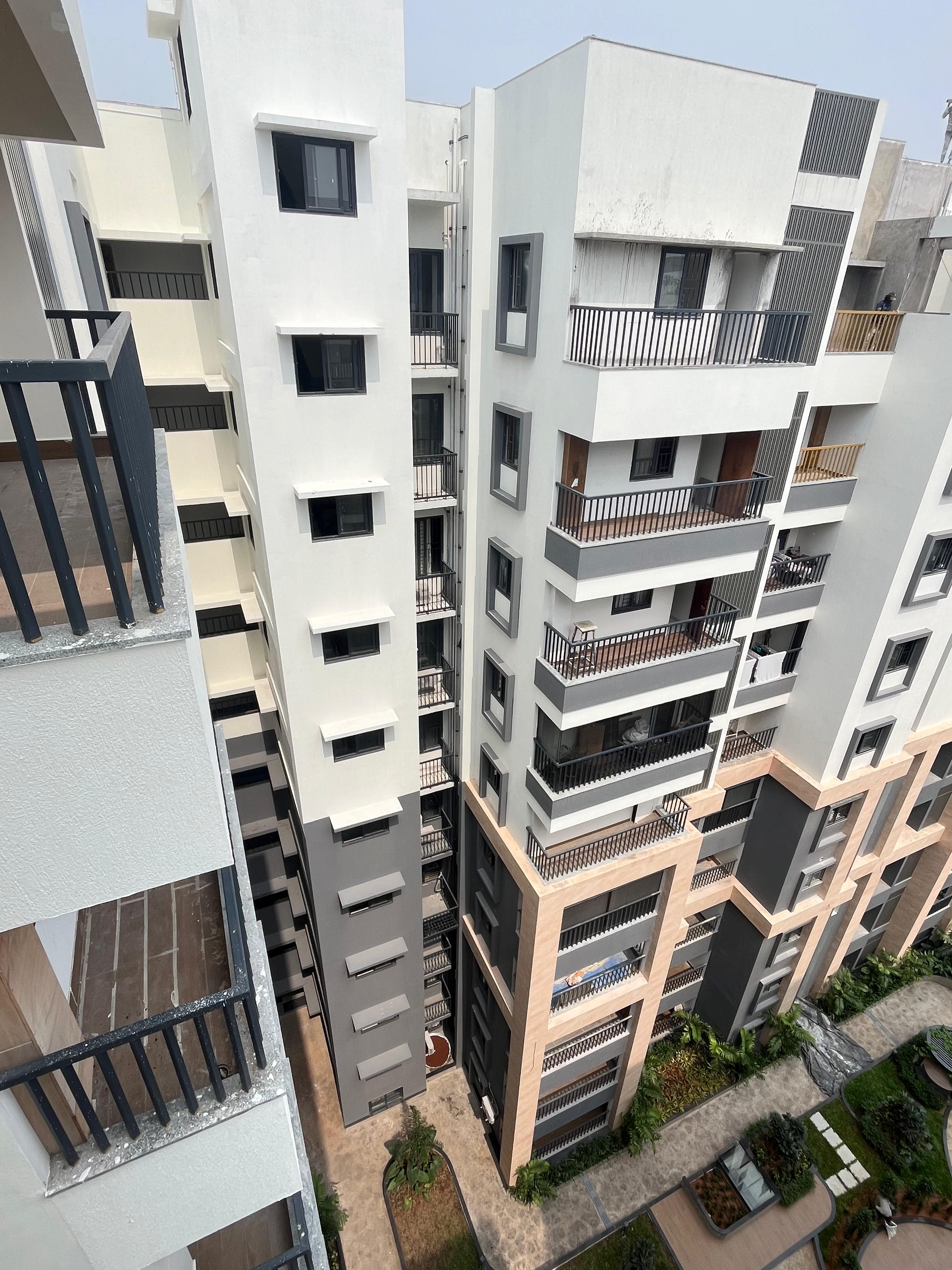

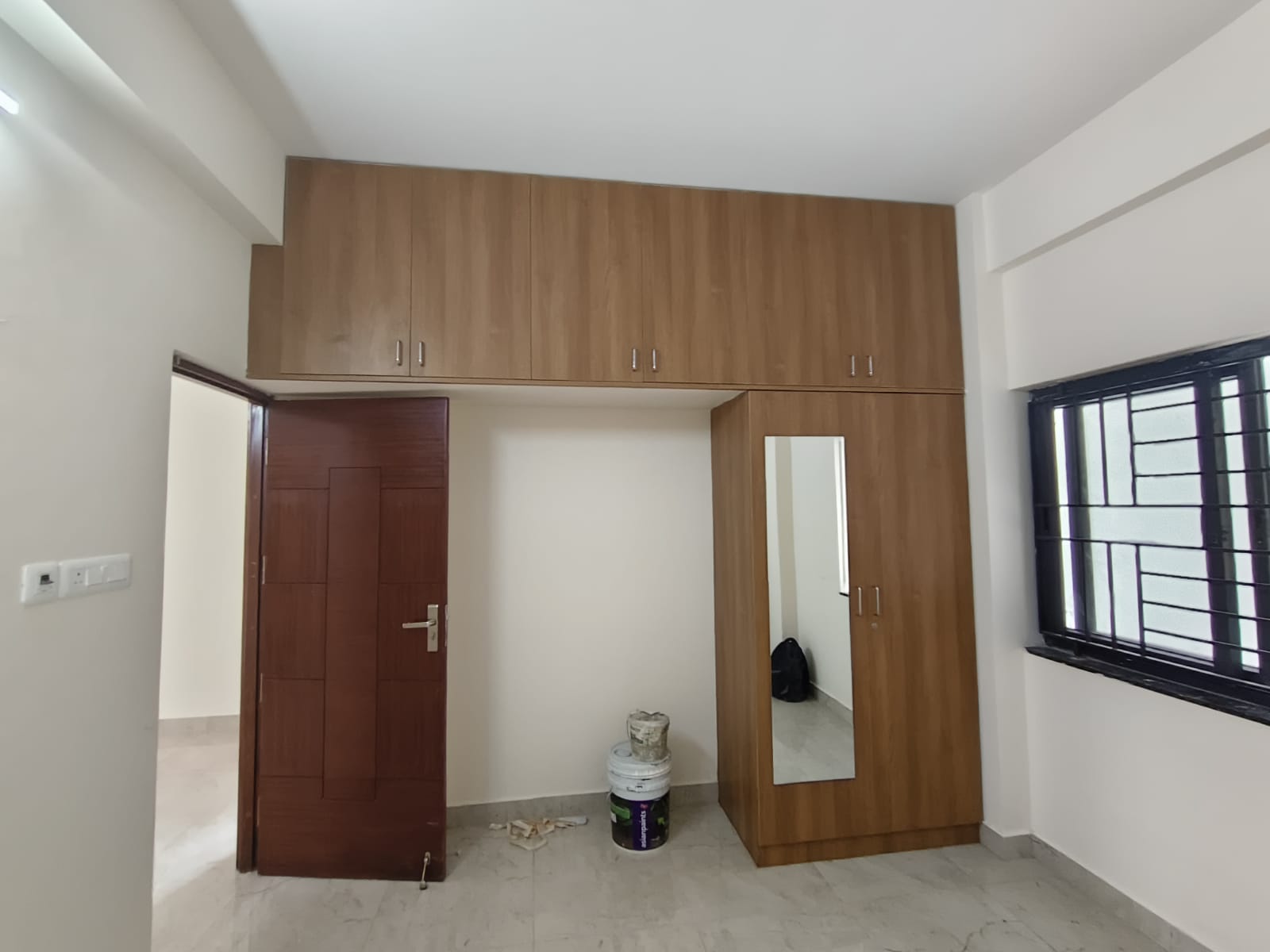

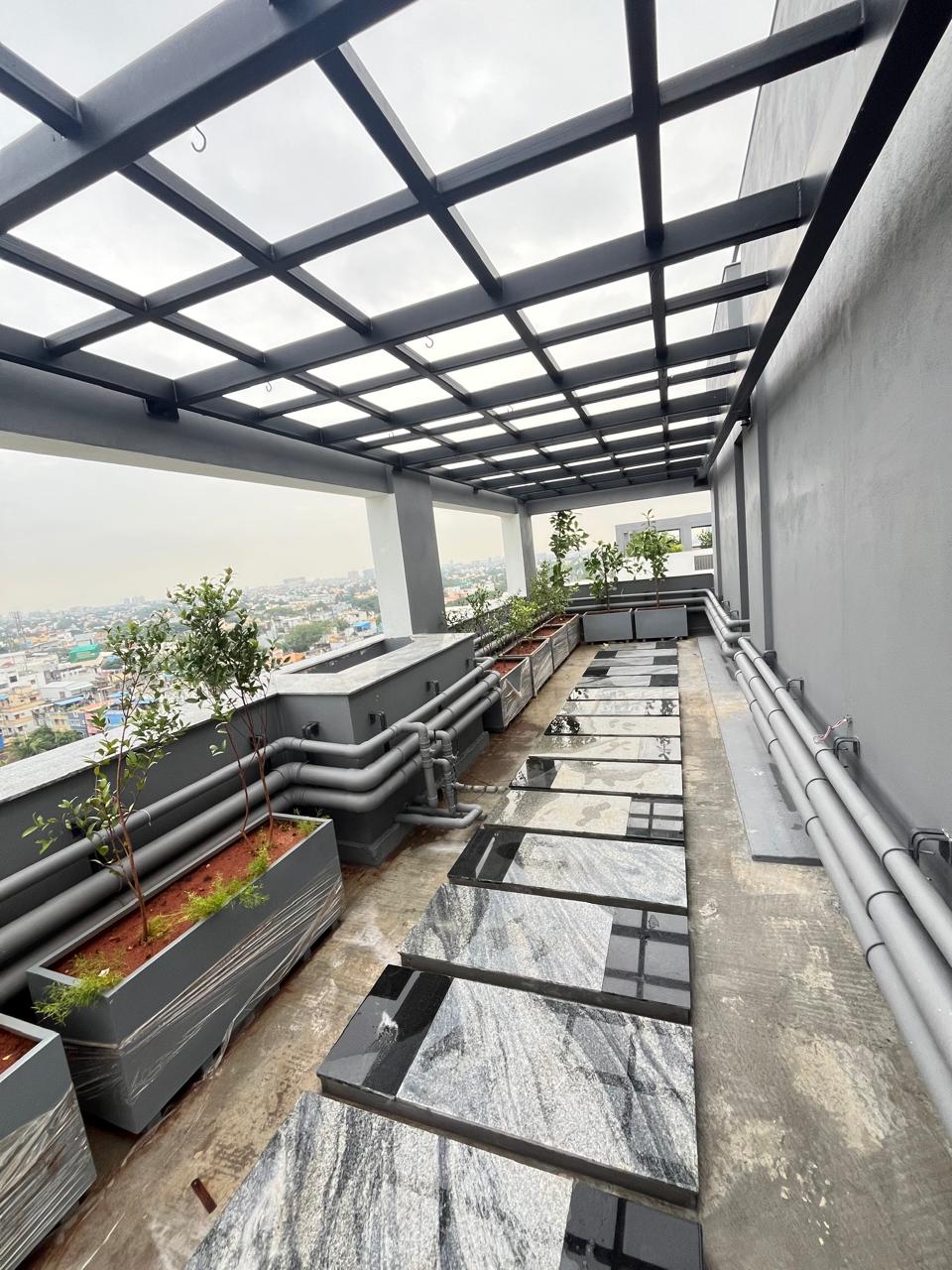

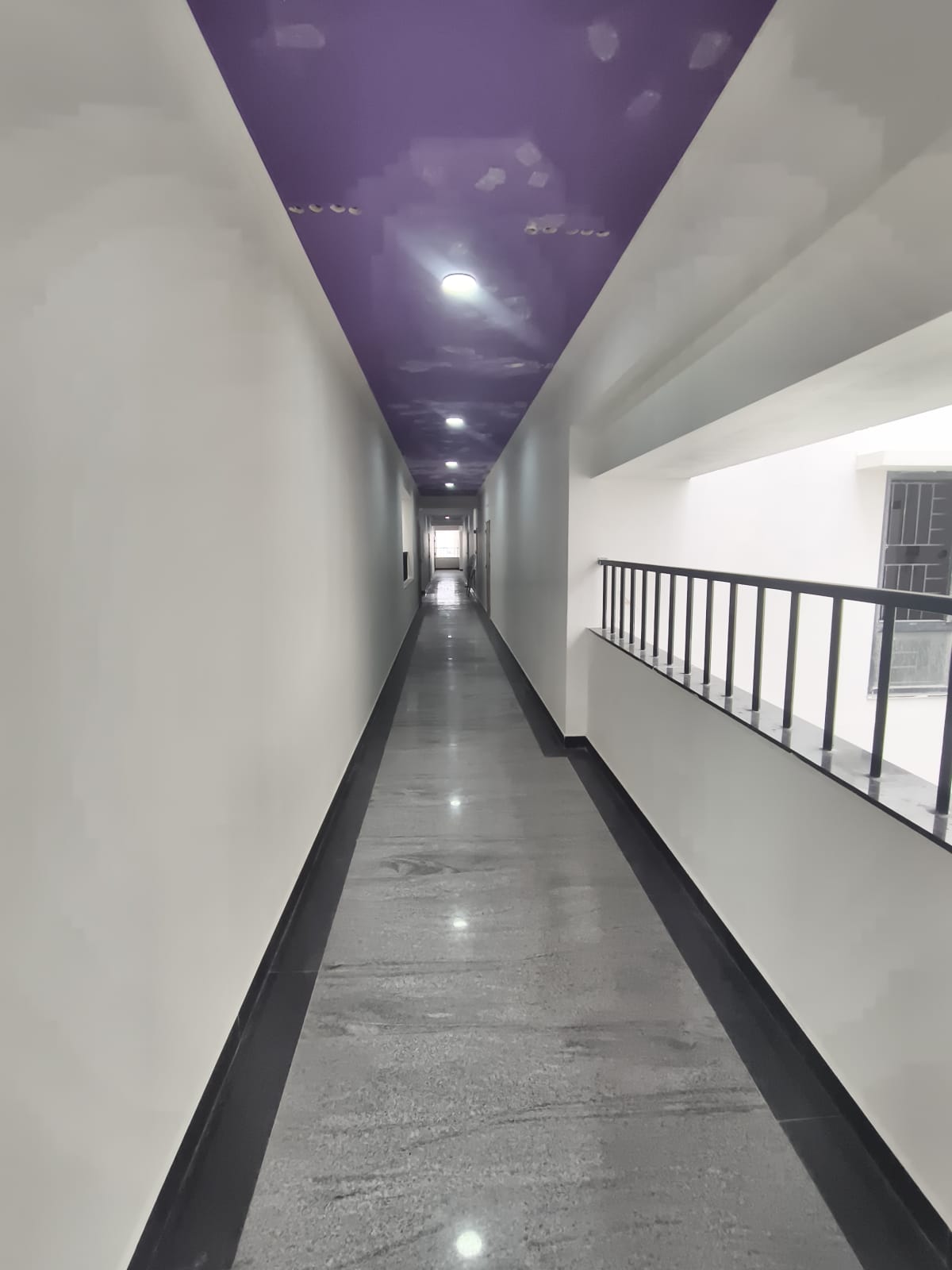

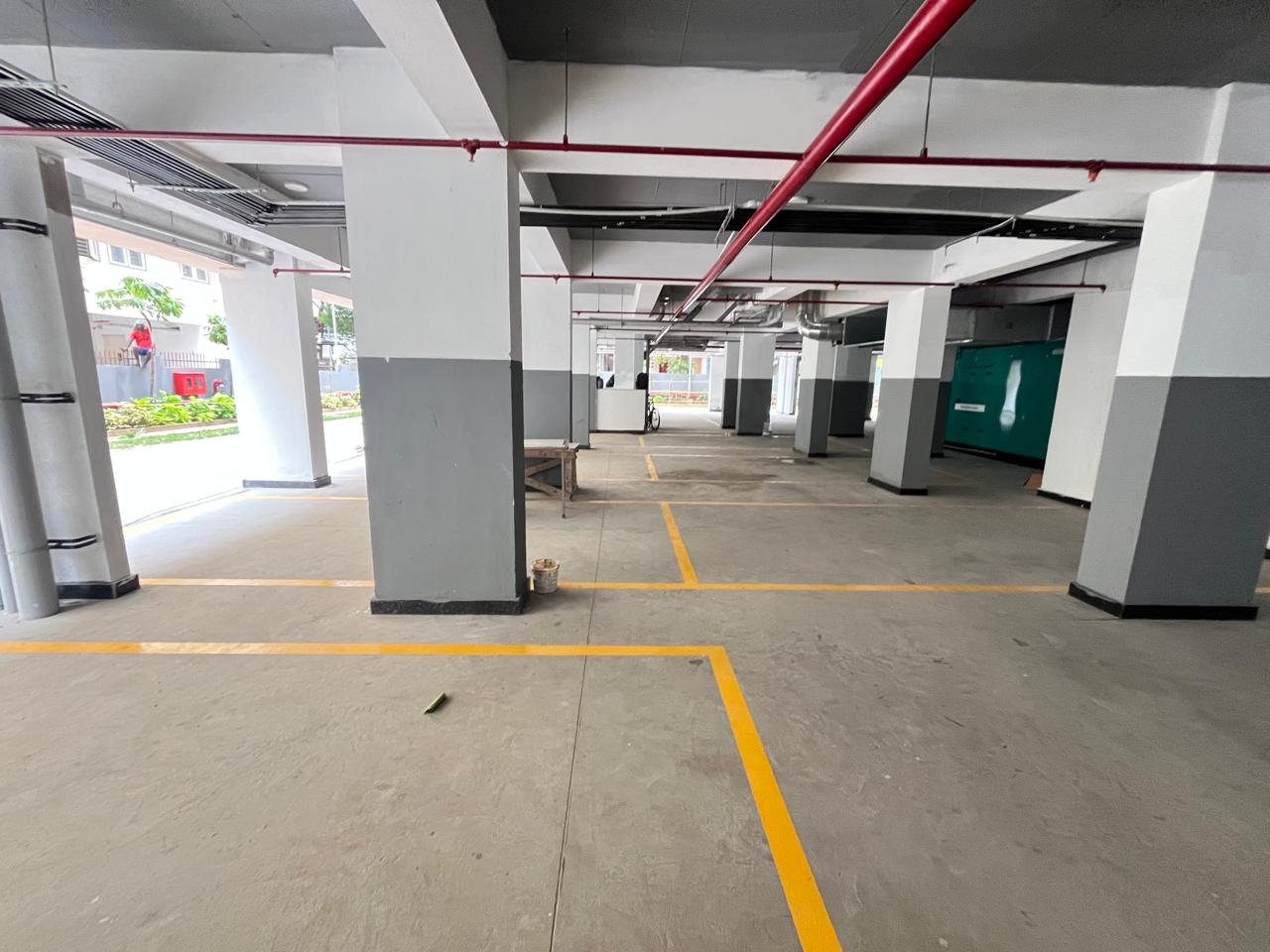

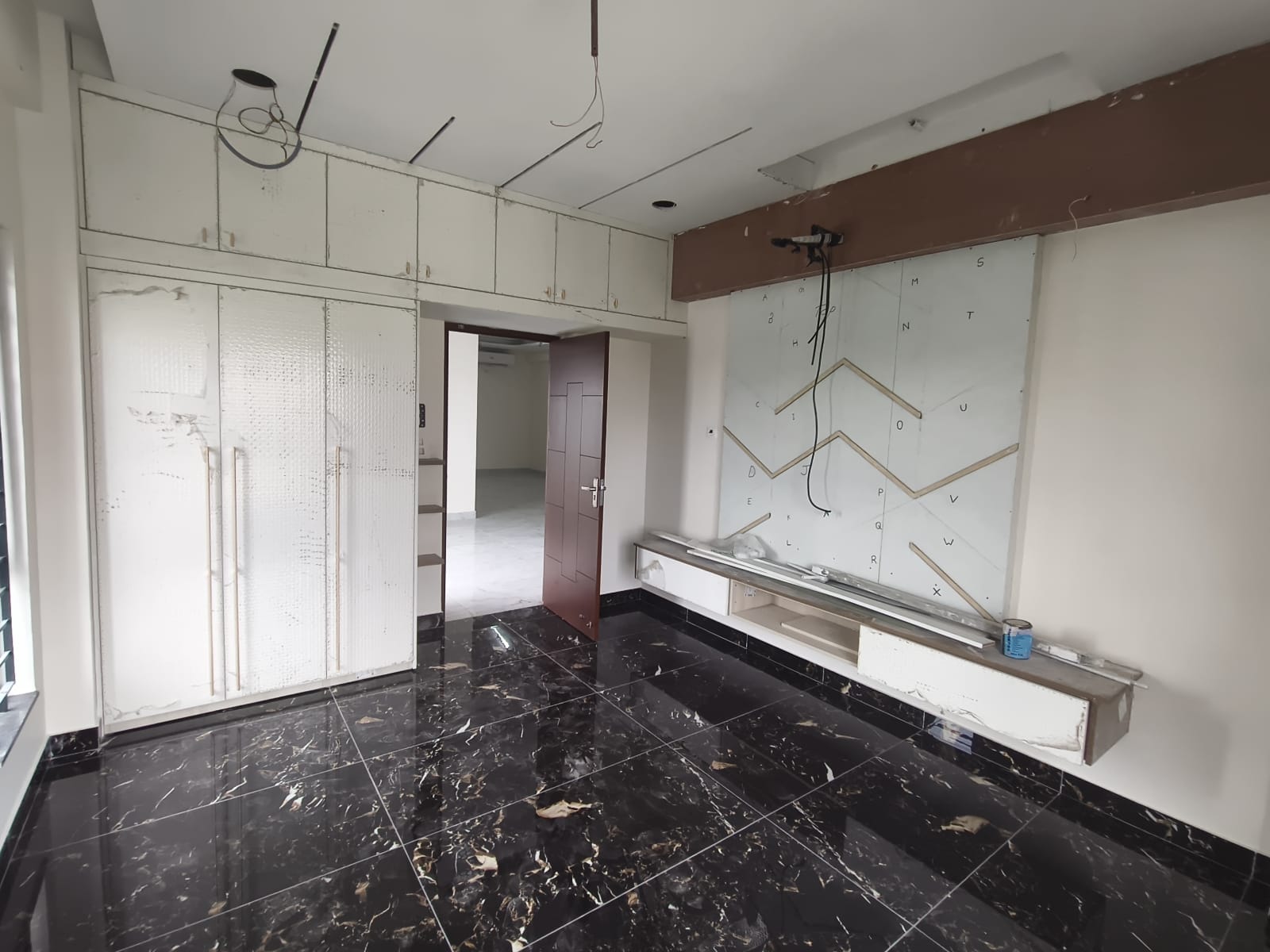

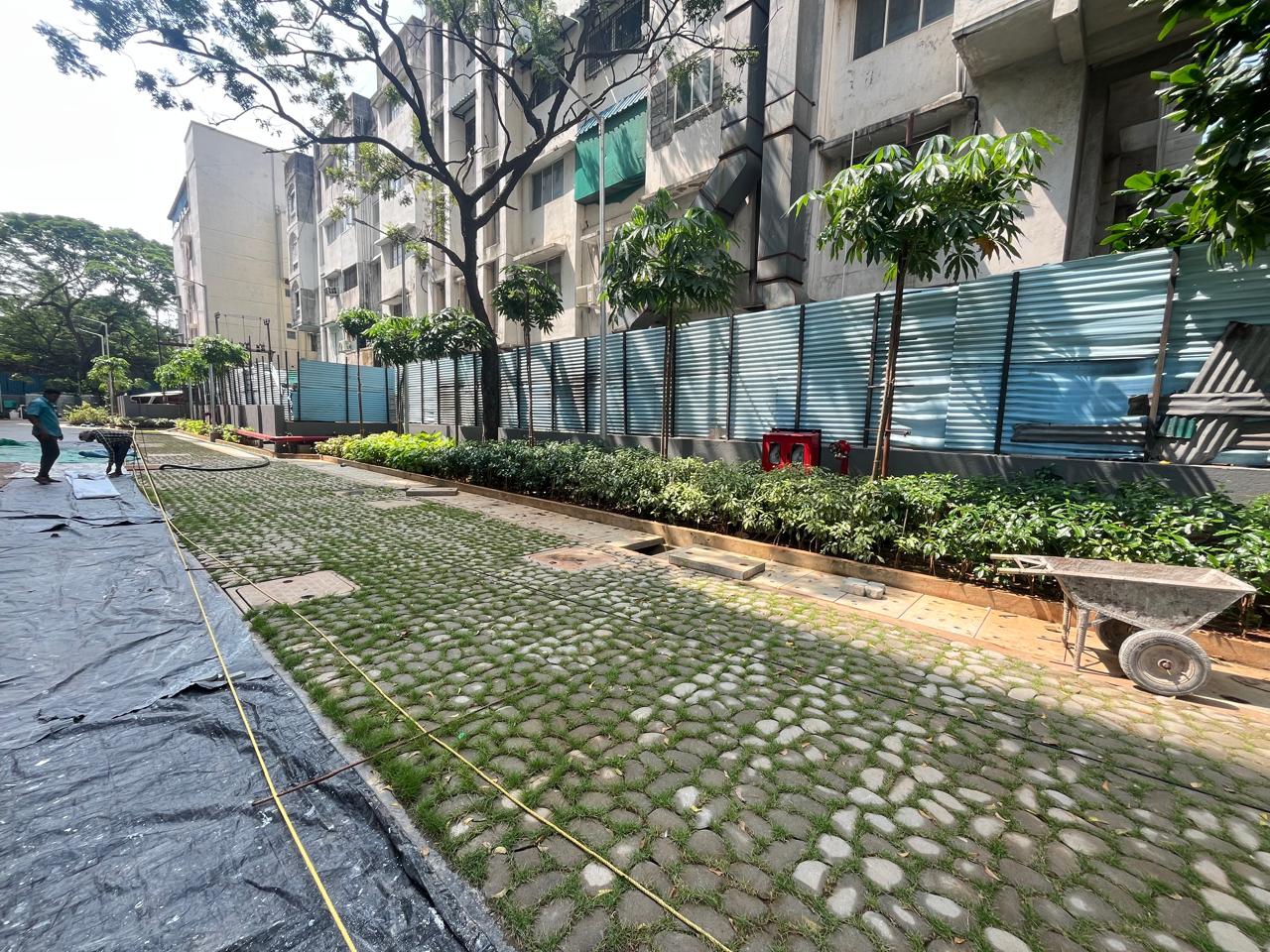

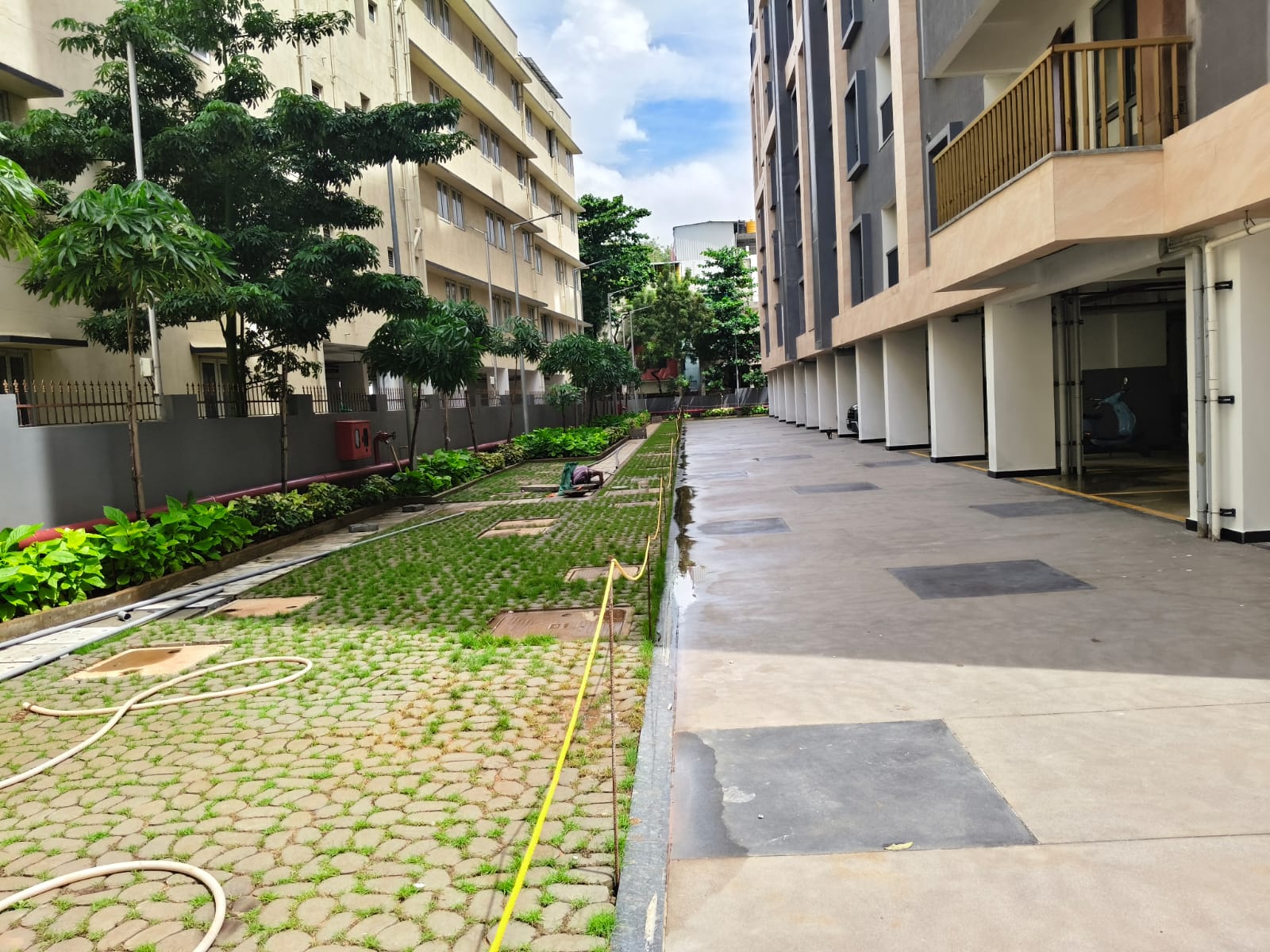

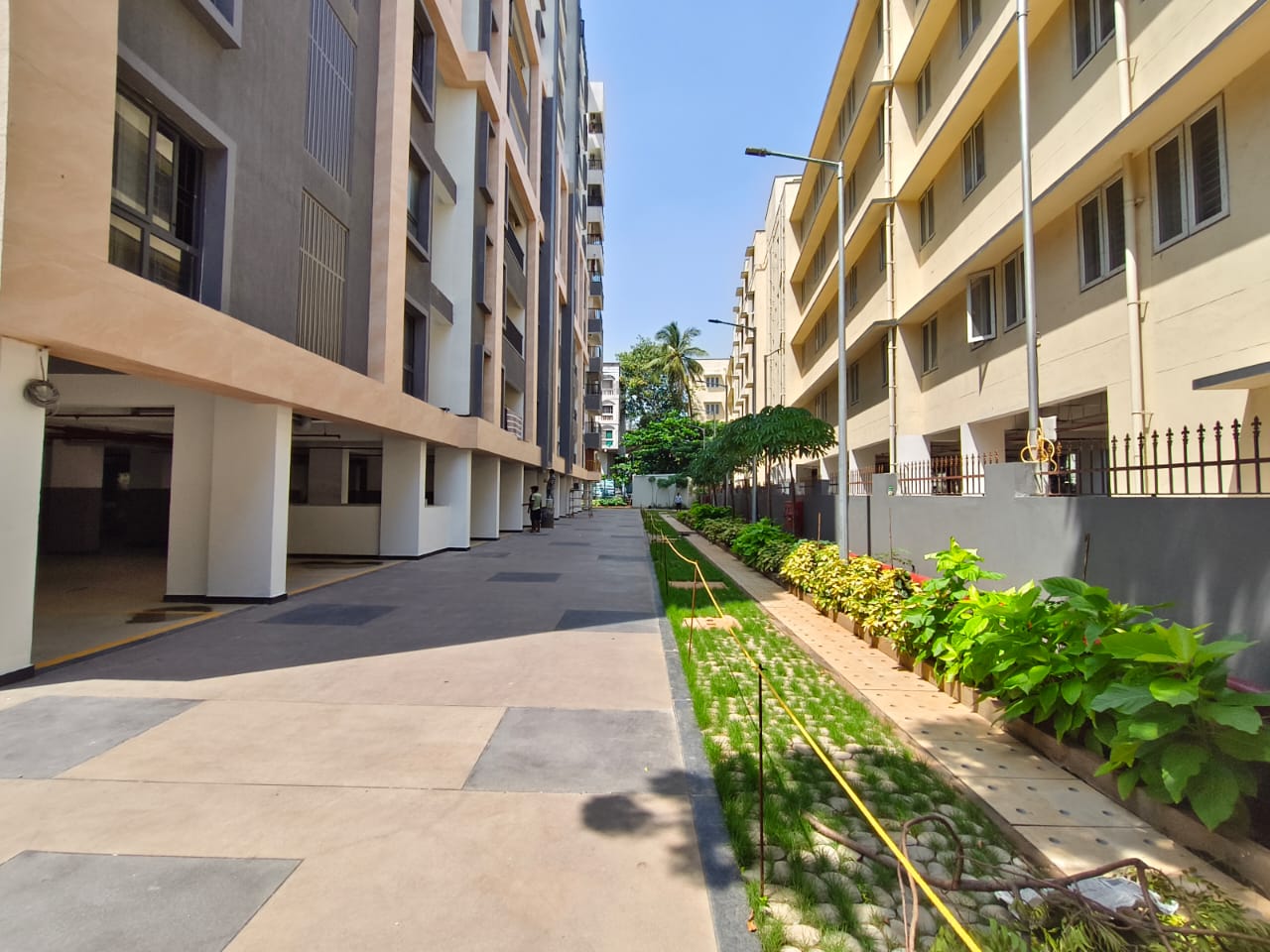

Project Update Images

  • All floors roof concrete work is completed.
  • 6th floor block work is completed.
  • 7th floor block work is in progress.
  • 1st & 2nd floor toilet plumbing work is in progress.
  • 1st floor inner wall plastering work is completed.
  • 2nd floor inner wall plastering work is in progress (60% completed)
  • 6th floor block work is completed.
  • 7th floor block work is completed.
  • 3rd floor inner plastering work is in progress. (60% completed)
  • 4th floor inner plastering work is in progress
  • Upto 4th floor toilet plumbing work is in progress.
  • External plastering button marking work is in progress.
  • Terrace parapet wall brick work is in progress.
  • 3rd floor inner plastering work is in progress. (60% completed)
  • 4th floor inner plastering work is in progress
  • Upto 4th floor toilet plumbing work is in progress.
  • 1st to 5th floor external plastering work is in progress.
  • Terrace parapet wall brick work is in progress. (30% completed)
  • 3rd floor inner plastering work is completed.
  • 4th floor inner plastering work is in progress
  • Upto 5th floor toilet plumbing work is in progress.
  • 1st to 5th floor external plastering work is in progress.
  • 8th floor block work is in progress. (30% completed)
  • Terrace parapet wall brick work is in progress. (90% completed)
  • 3rd floor inner plastering work is completed.
  • 4th and 5th floor inner plastering work is in progress
  • Upto 5th floor toilet plumbing work is in progress.
  • 1st to 5th floor external plastering work is in progress.

Property Location

Let your dreams be our

next Project!
