Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 sales@ramaniyam.com

Ankur

Thiruvanmyur

Download Brochure

Download file

Enquire Now

Amenities

Elevators
24/7 Power Backup
Rain Water Harvesting

Master Layout Plan

Approvals

Planning Permit No:

PP / NHRB / 101 /2022

Date of Permit:

2022-04-13

Building Permission No:

CEBA / WDCN13 / 00122 / 2022

Date of Permit:

2022-04-27

TNRERA:

TN / 29 / Building / 0191 / 2022

Dated:

2022-05-27

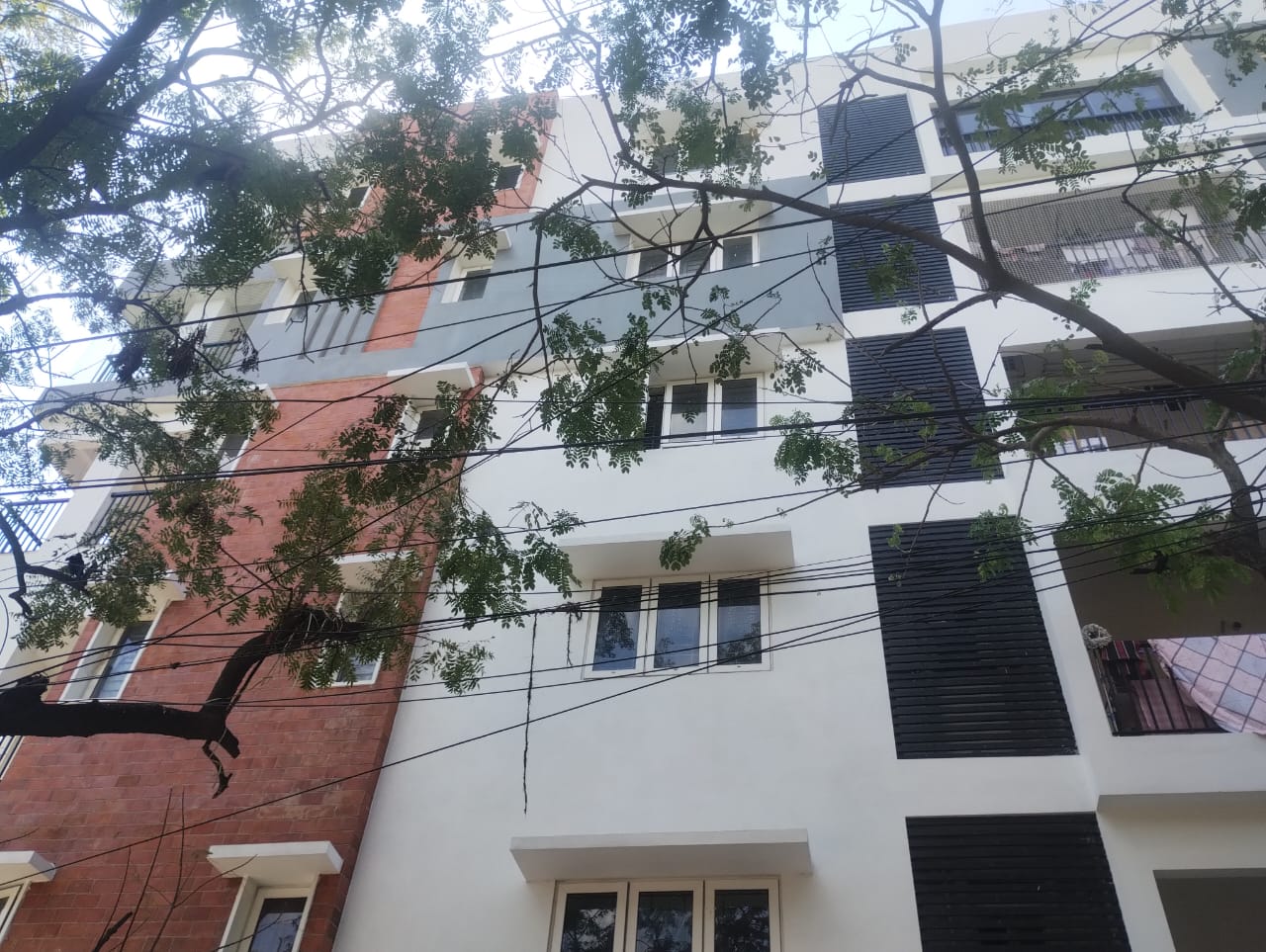

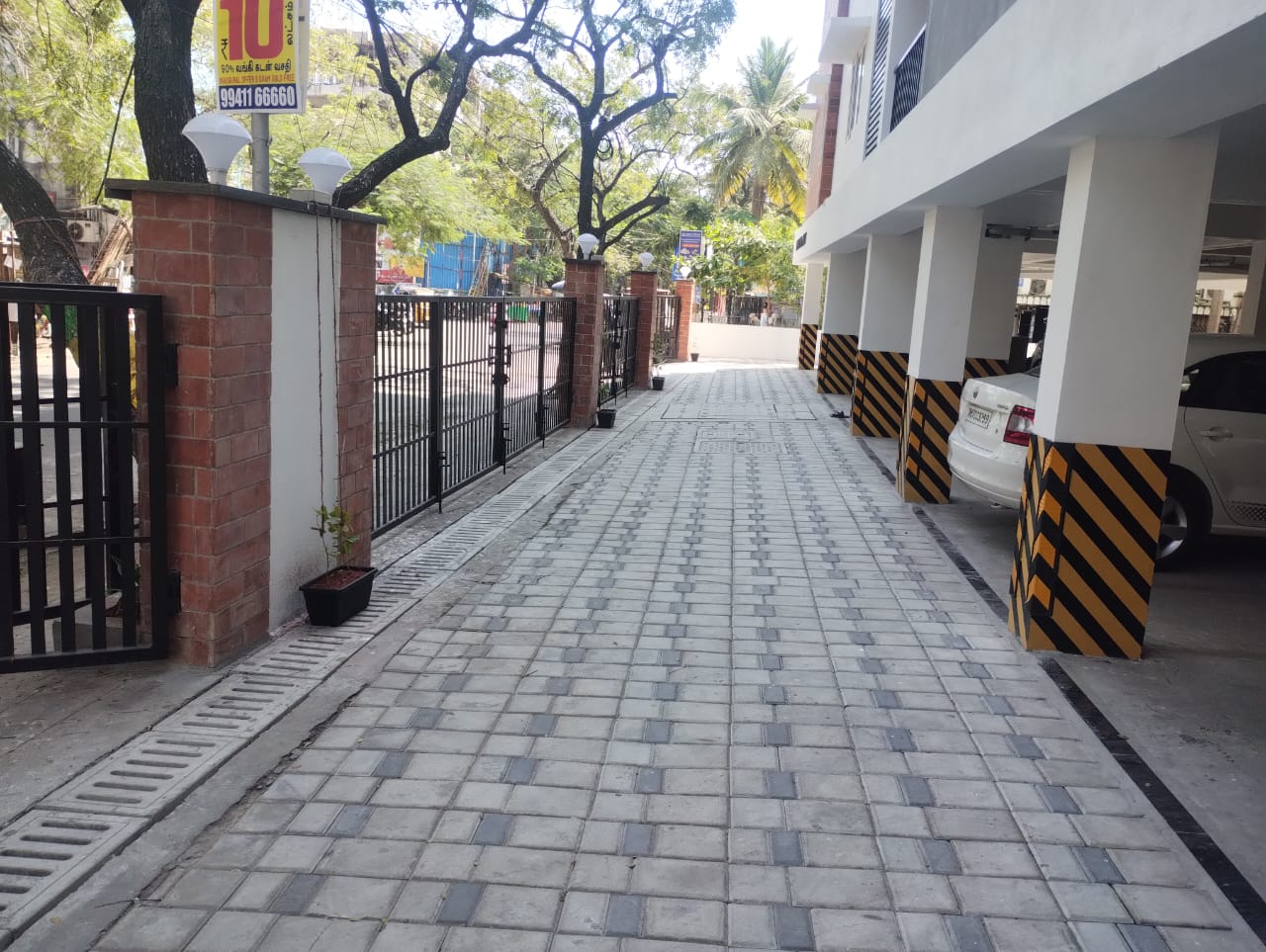

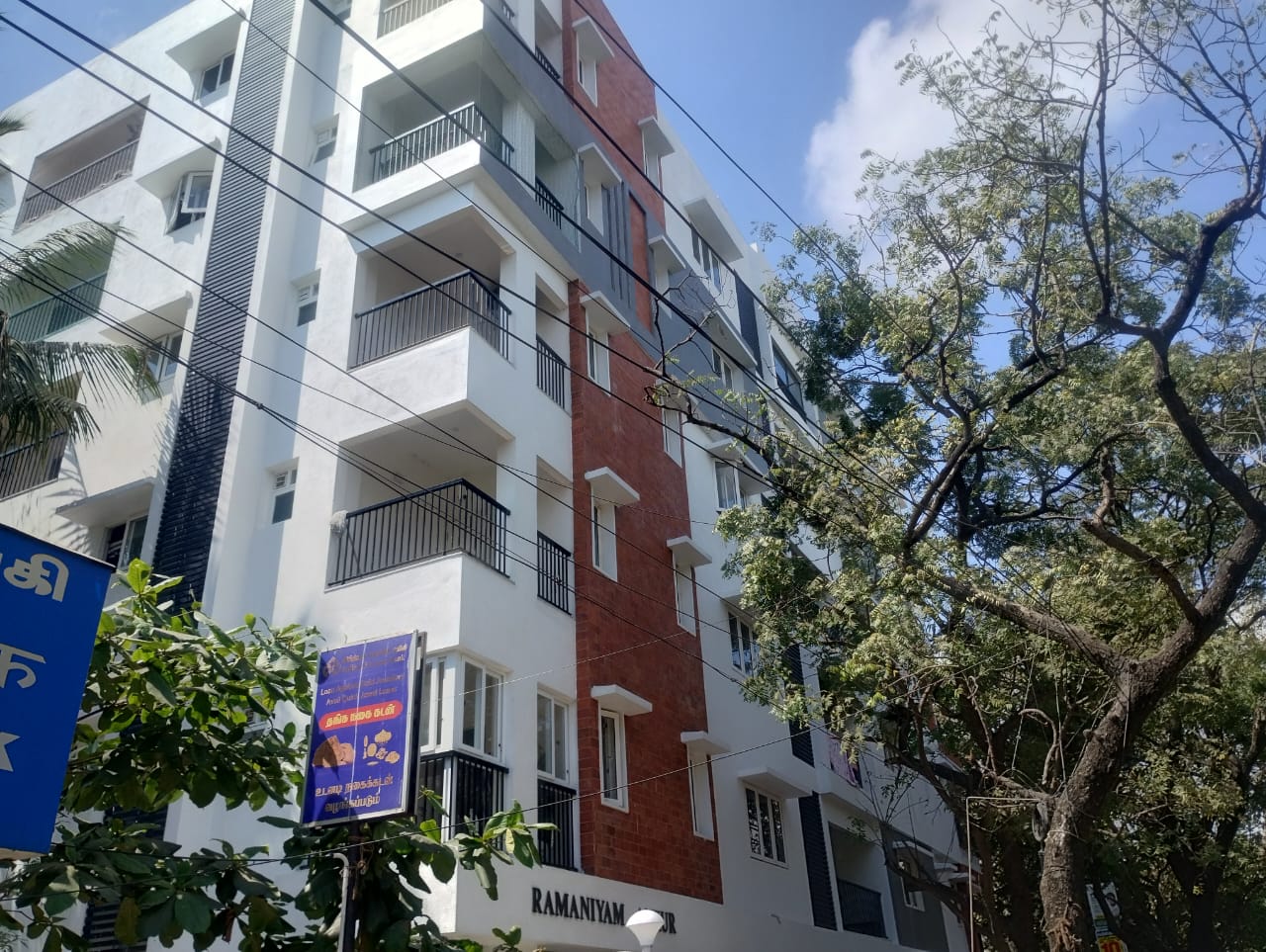

Project Update Images

  • 5th floor general flooring work is in progress. (50% completed)
  • Lobby flooring work is 95% completed.
  • Elevation tile fixing work is in progress. (30% completed)
  • External plumbing work is in progress. (20% completed)
  • External 1st coat painting work is in progress. (50% completed)
  • External chamber work is in progress. (35% completed)
  • All floors general flooring work is completed. (Except 5B Flat)
  • Lobby flooring work is 95% completed.
  • Elevation tile fixing work is in progress. (30% completed)
  • External plumbing work is in progress. (50% completed)
  • External 1st coat painting work is in progress. (60% completed)
  • External chamber work is in progress. (70% completed)
  • All floors general flooring work is completed. (Except 5B Flat)
  • 3rd , 4th & 5th Inner primer work is in progress.
  • Elevation tile fixing work is in progress. (80% completed)
  • External plumbing work is in progress. (60% completed)
  • External 1st coat painting work is in progress. (60% completed)
  • External chamber work is in progress. (80% completed)
  • Lift erection work is in progress.
  • Outer Texture painting work is in progress.
  • Wood work is in progress ( Flat -5A&5C )
  • All floors general flooring work is completed. (Except 5B Flat)
  • 3rd , 4th & 5th Inner primer work is in progress.
  • Elevation tile fixing work is in progress. (80% completed)
  • External plumbing work is in progress. (60% completed)
  • External 1st coat painting work is in progress. (60% completed)
  • External chamber work is in progress. (80% completed)
  • Lift erection work is in progress.
  • Outer Texture painting work is in progress.
  • Wood work is in progress ( Flat -5A&5C )
  • 1st, 2nd floor Inner primer work is in progress.
  • External plumbing work is in progress. (80% completed)
  • External 1st coat painting work is in progress. (60% completed)
  • External chamber work is in progress. (80% completed)
  • Lift erection work is in progress. (40% completed)
  • All floor lift wall cladding work is in progress.
  • Terrace weathering course work is in progress (70% completed)
  • Wood work is in progress ( Flat -5A&5C )
