Contact Us

Ramaniyam Real Estates,

14/67, 3rd Main Rd,

Gandhi Nagar, Adyar

Chennai 600 020

+91 4443447500 +91 9710928855 +91 7299922617 sales@ramaniyam.com

Shyamala

Mandaveli

Download Brochure

Download file

Enquire Now

Amenities

Generator Backup
CCTV
Rain Water Harvesting

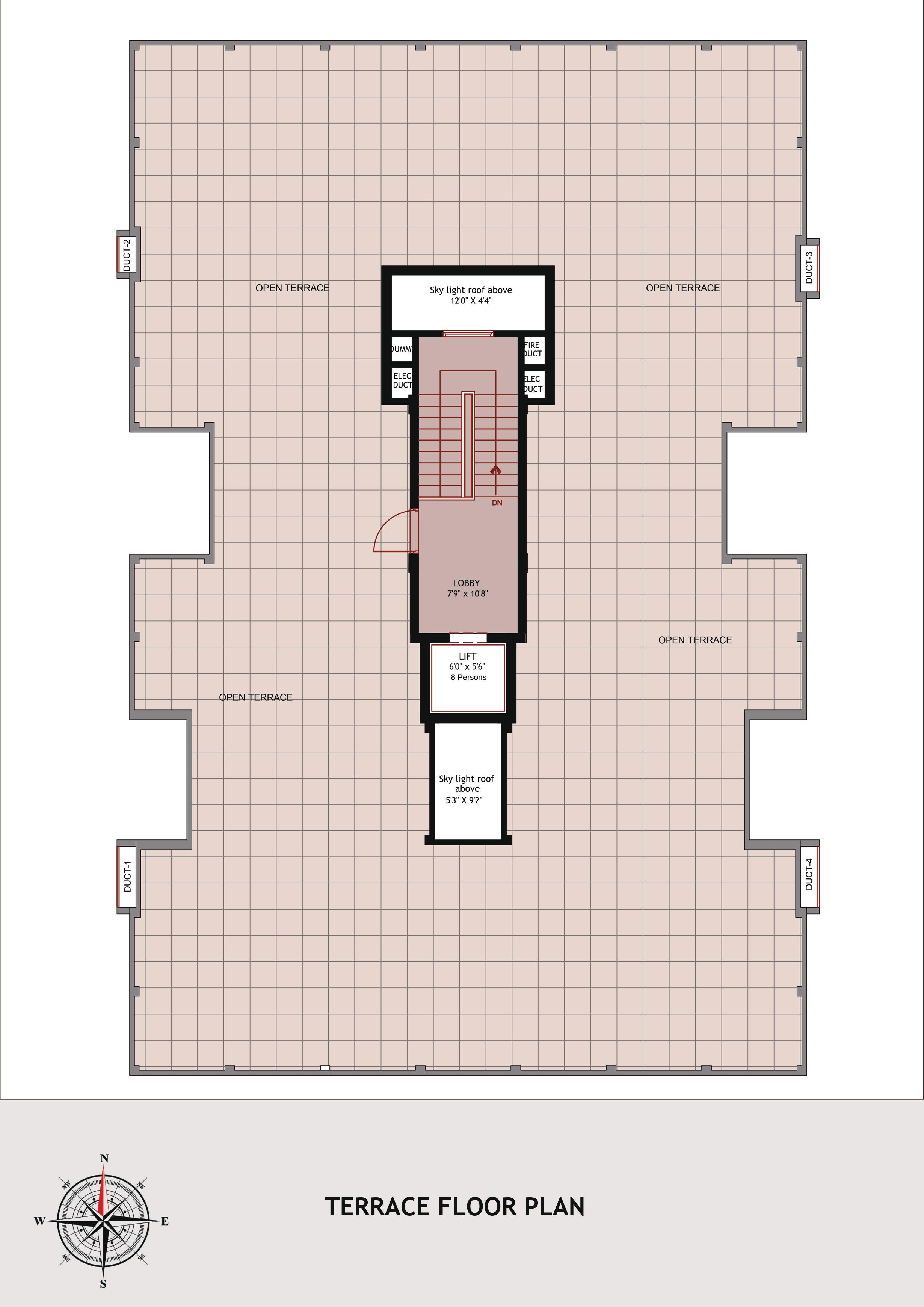

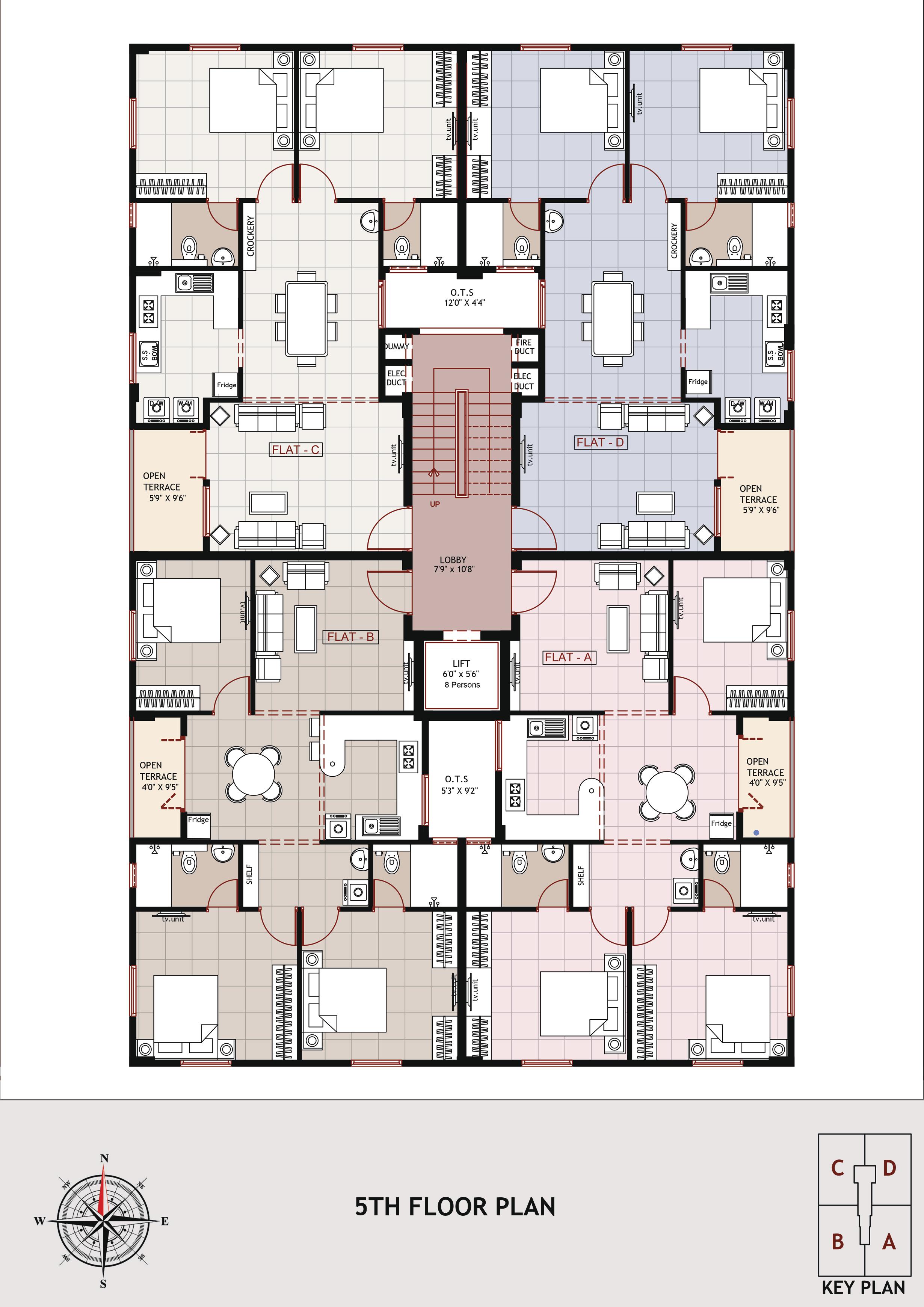

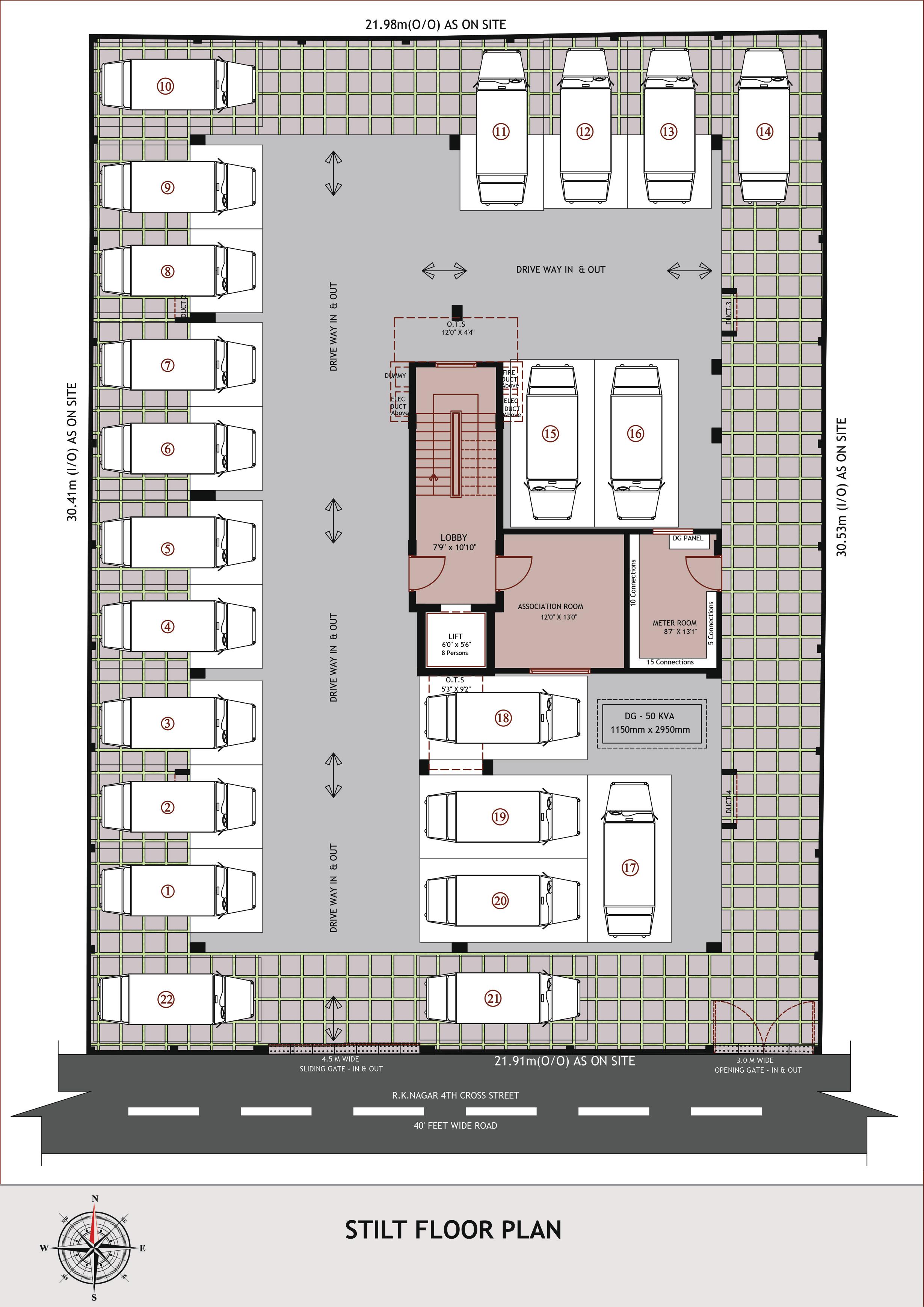

Master Layout Plan

Availability

Flat No. Floor Type Area Facing Layout Availability
2A 2 3BHK + 2T 1077 West Not Available Sold Out
3C 3 2BHK + 2T 1036 East Not Available Sold Out
4A 4 3BHK + 2T 1077 West Not Available Sold Out
4B 4 3BHK + 2T 1077 East Not Available Sold Out
1D 1 2BHK + 2T 1036 West Available
3A 1 3BHK + 2T 1077 North Sold Out
1B 1 3BHK + 2T 1077 North Sold Out
3B 1 3BHK + 2T 1077 North Sold Out
1A 1 3BHK + 2T 1077 North Sold Out
2D 2 2BHK + 2T 1036 West Available
1C 1 2BHK + 2T 1036 East Available
2C 2 2BHK + 2T 1036 East Available
3D 1 2BHK + 2T 1036 North Sold Out
5D 5 2BHK + 2T 972 West Available
4D 4 2BHK + 2T 1036 West Available
4C 4 2BHK + 2T 1036 East Available
5C 5 2BHK + 2T 972 East Available
5A 5 3BHK + 2T 1038 West Available
2B 1 3BHK + 2T 1077 North Sold Out
5B 1 3BHK + 2T 1038 North Sold Out

Approvals

Planning Permit No:

OL-PP/NHRB/0189/2023

Date of Permit:

2023-05-23

Building Permission No:

CEBA/WDCN13/00216/2023

Date of Permit:

2023-06-08

TNRERA:

TN/29/Building/284/2023

Dated:

2023-06-30

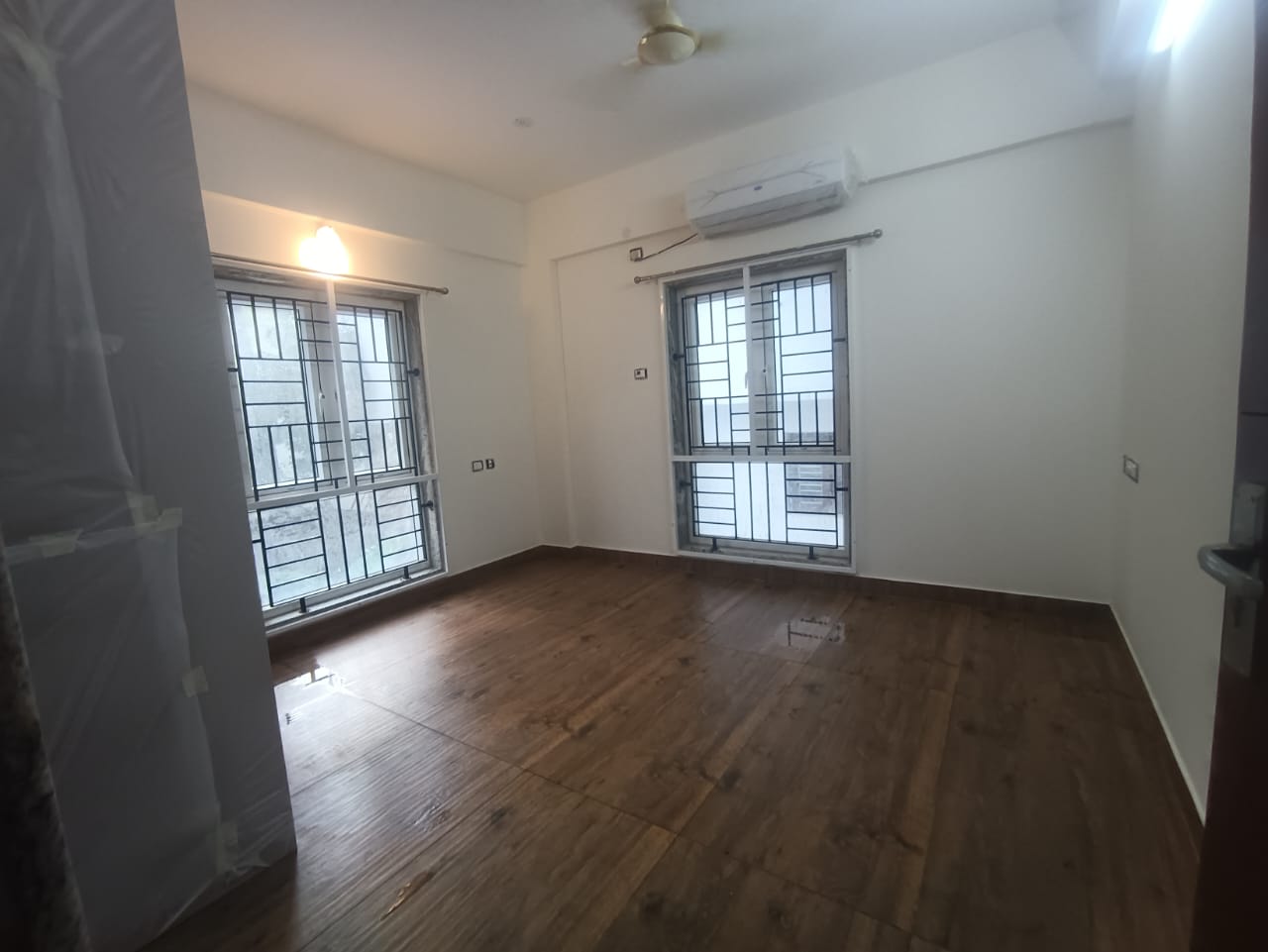

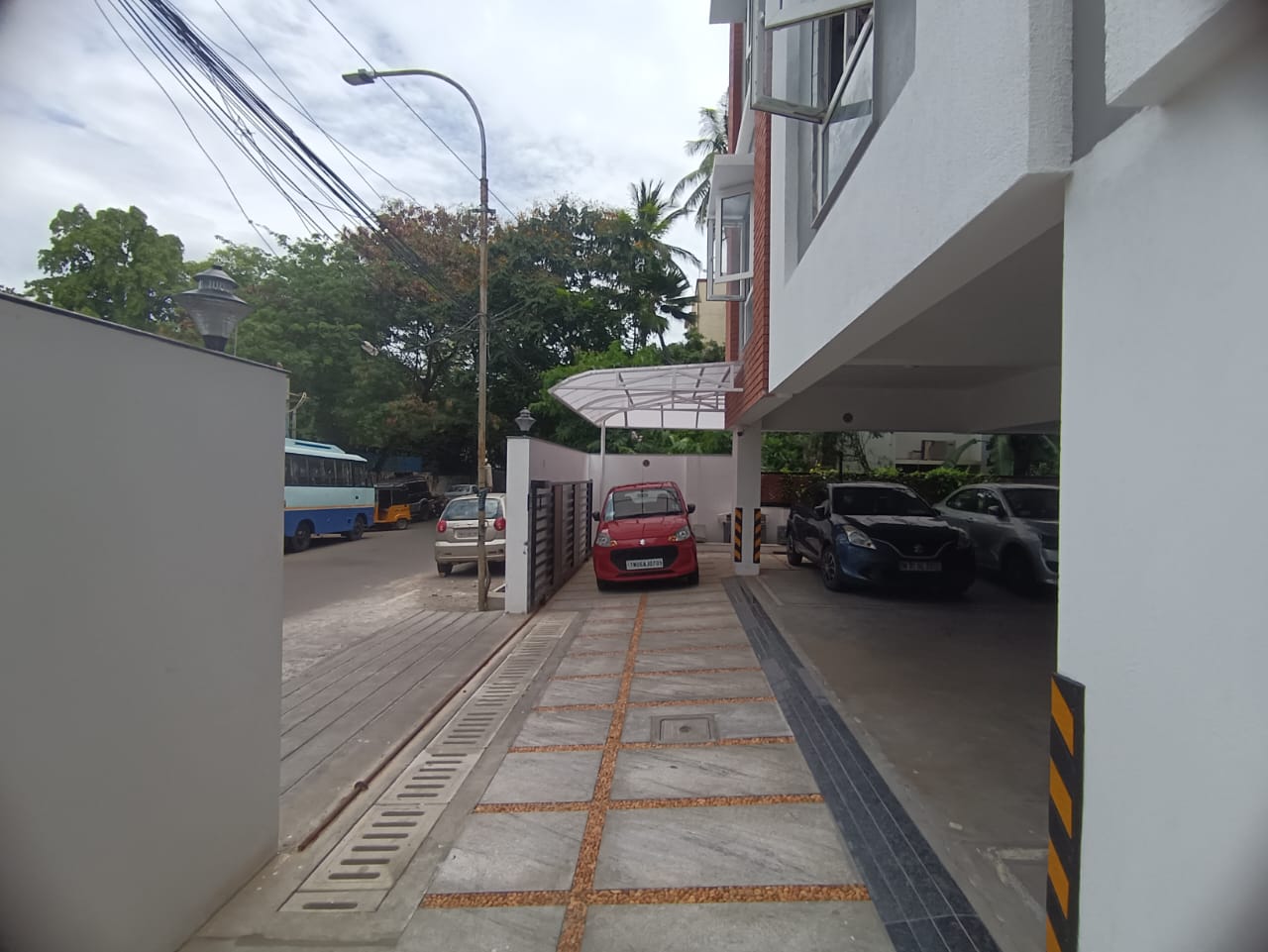

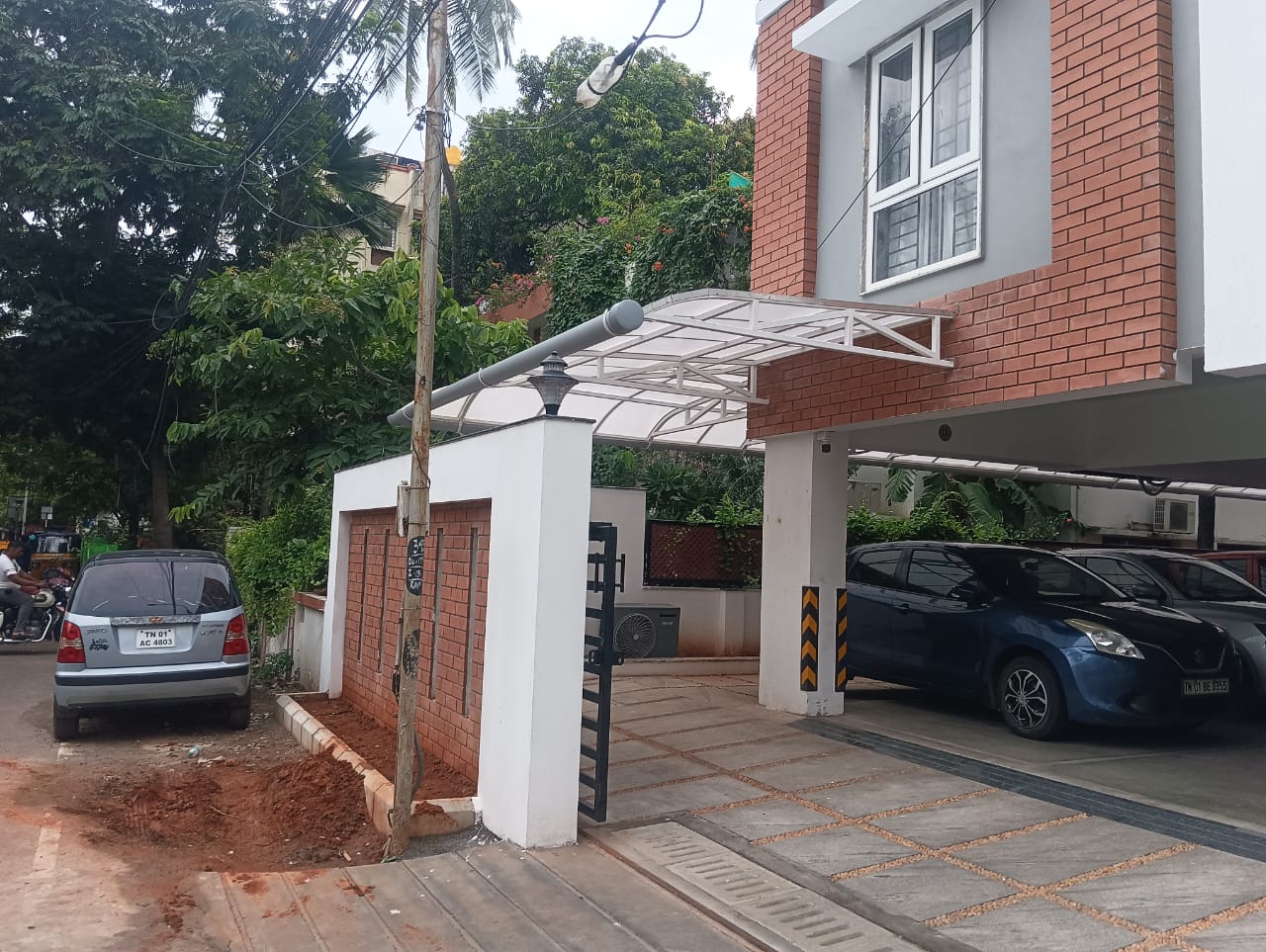

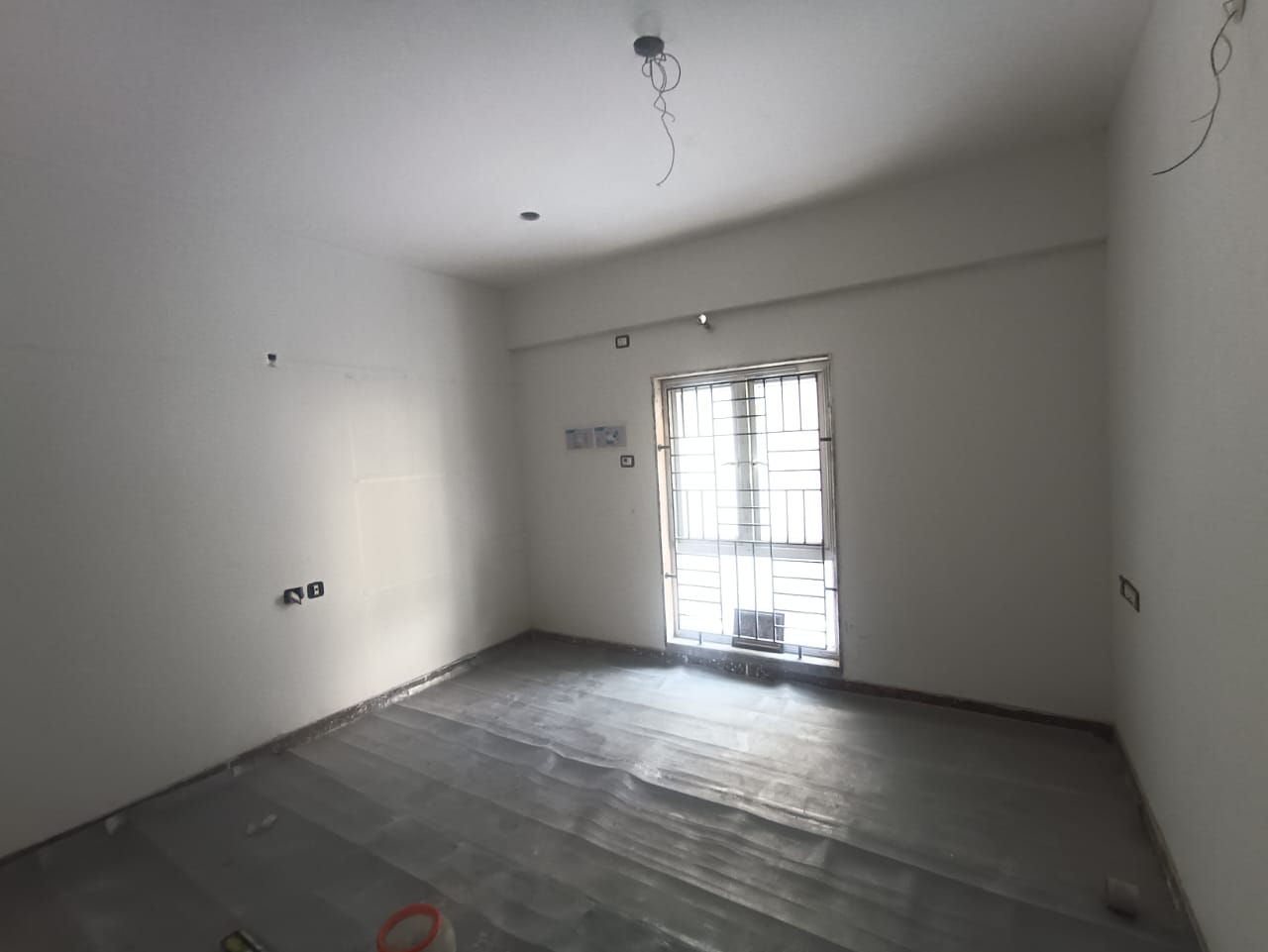

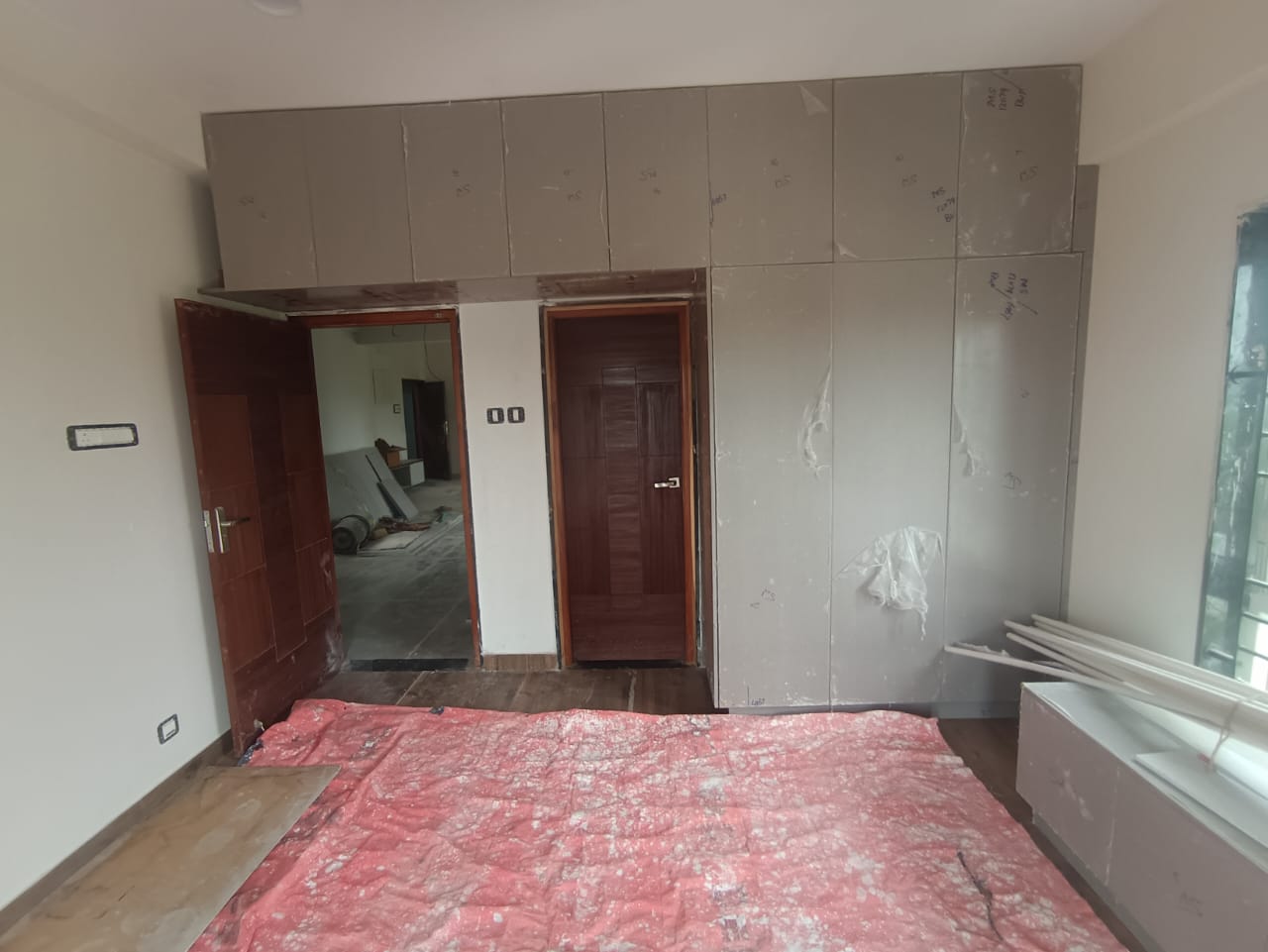

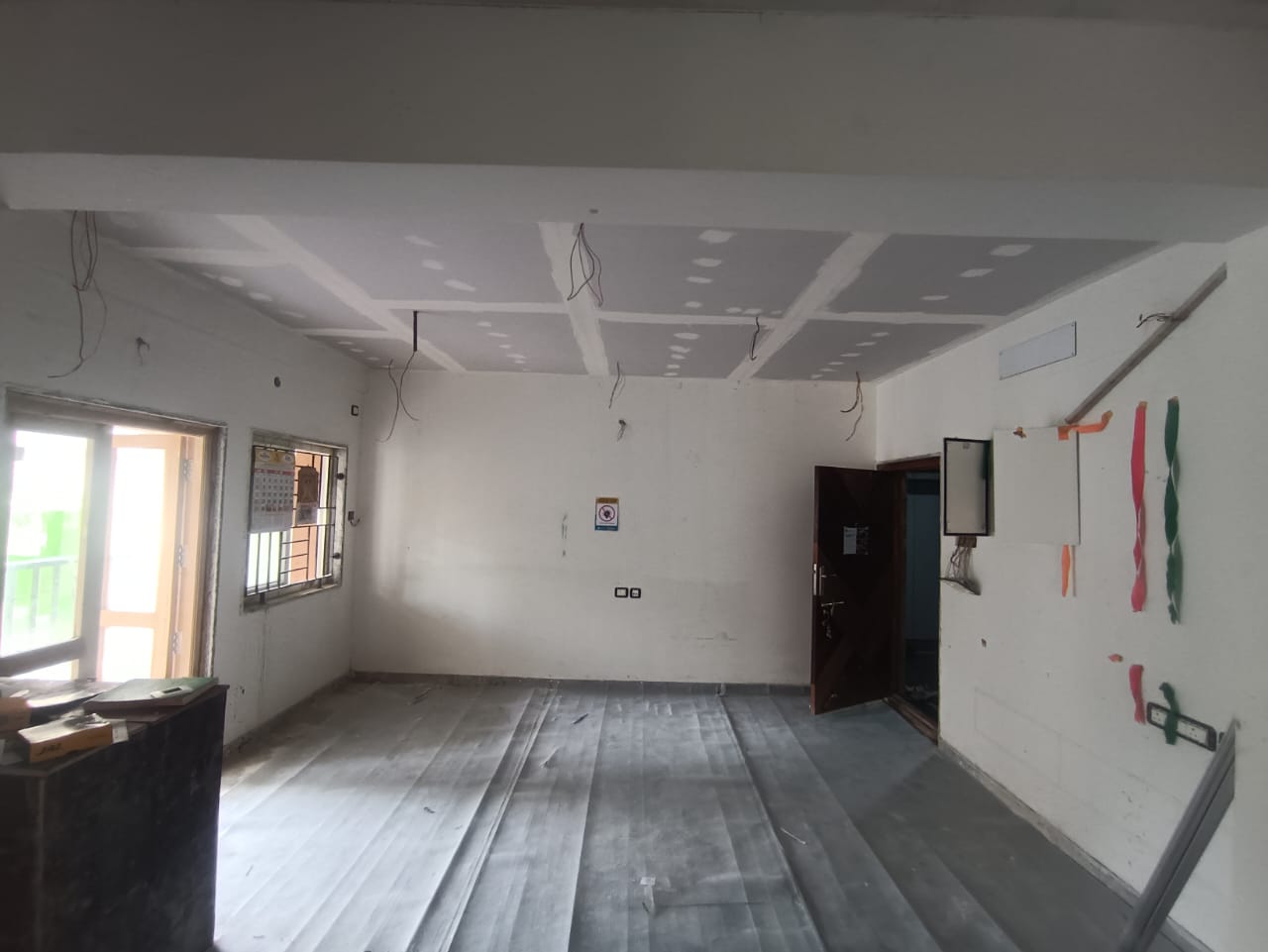

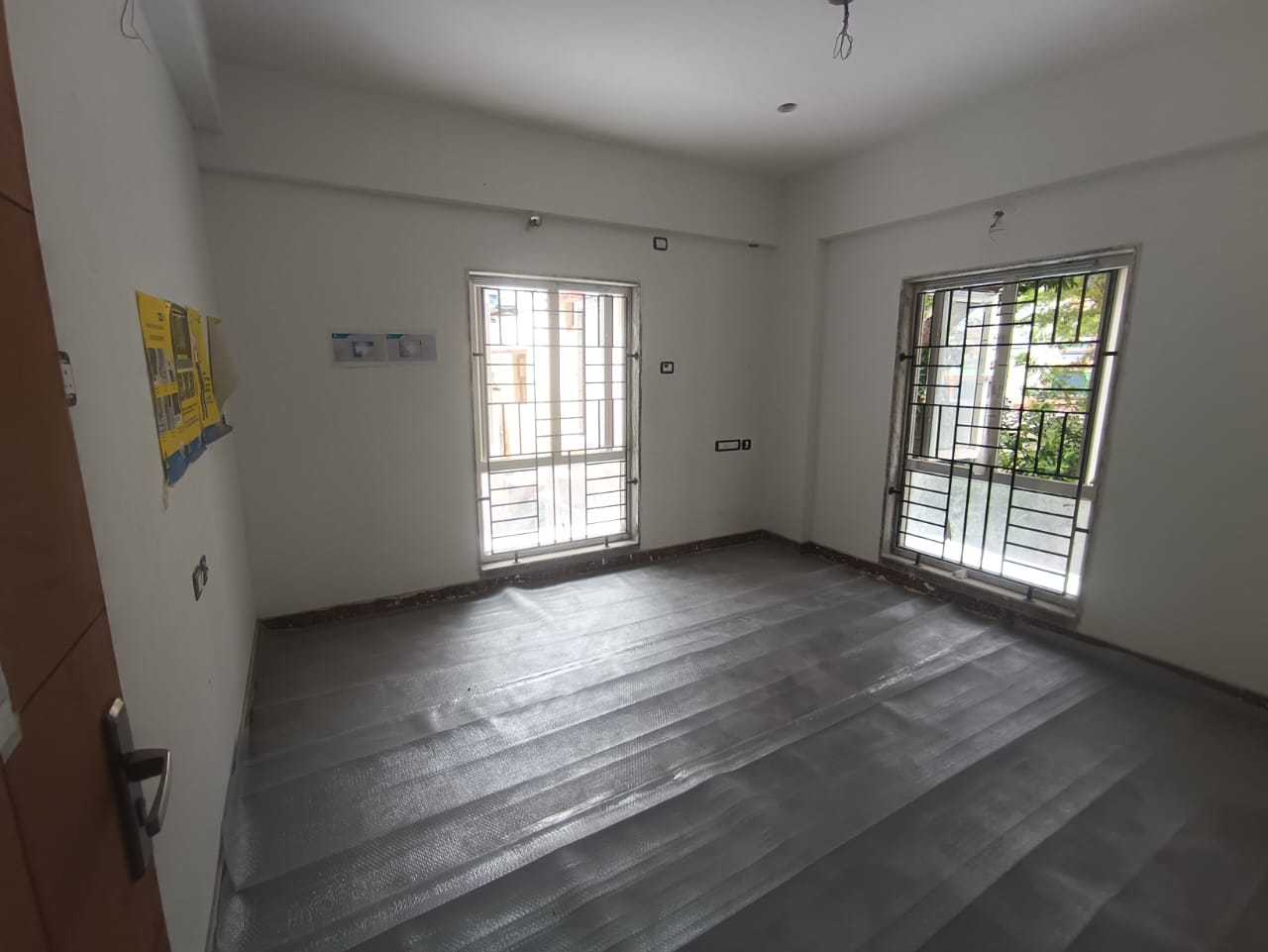

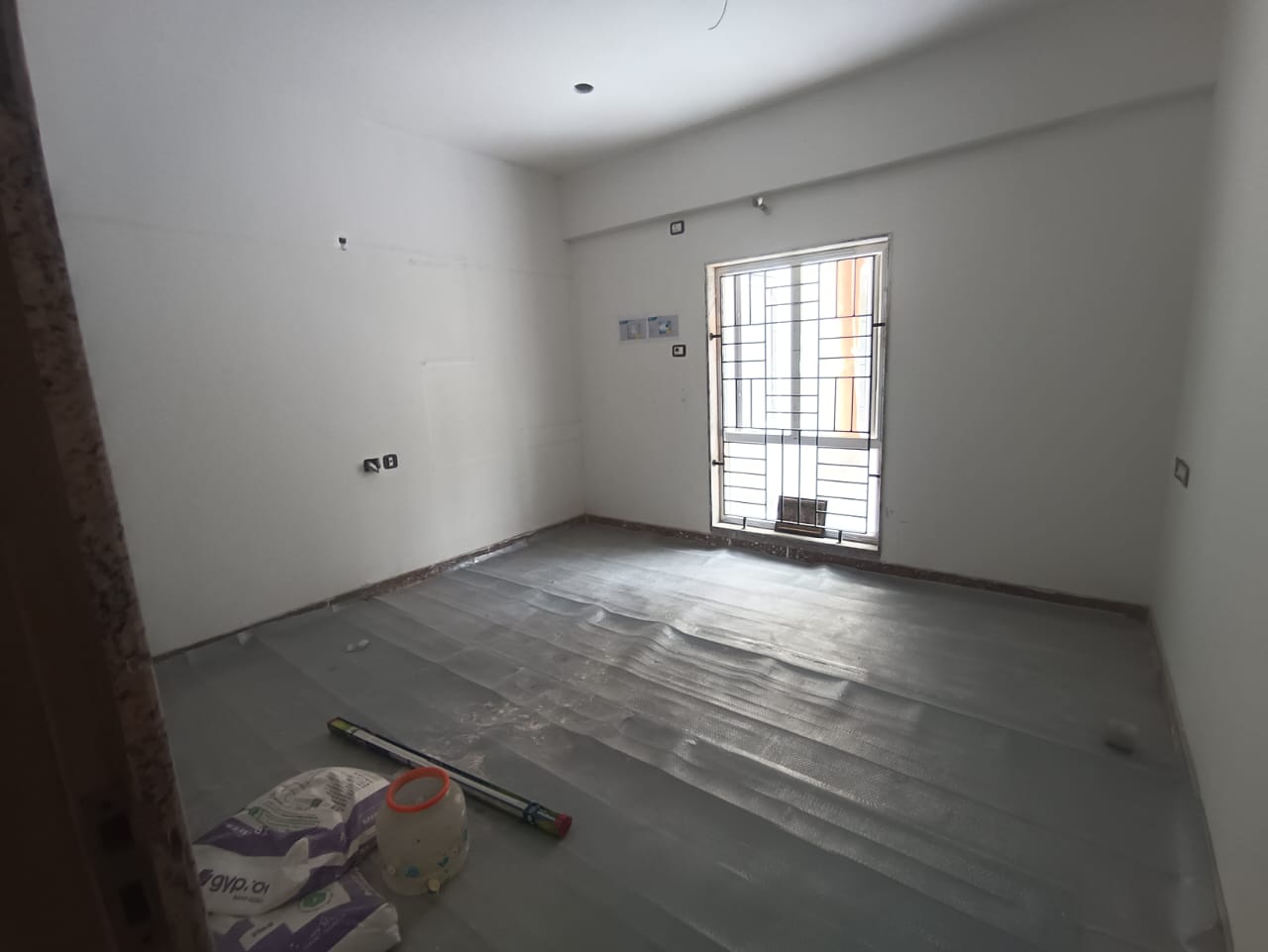

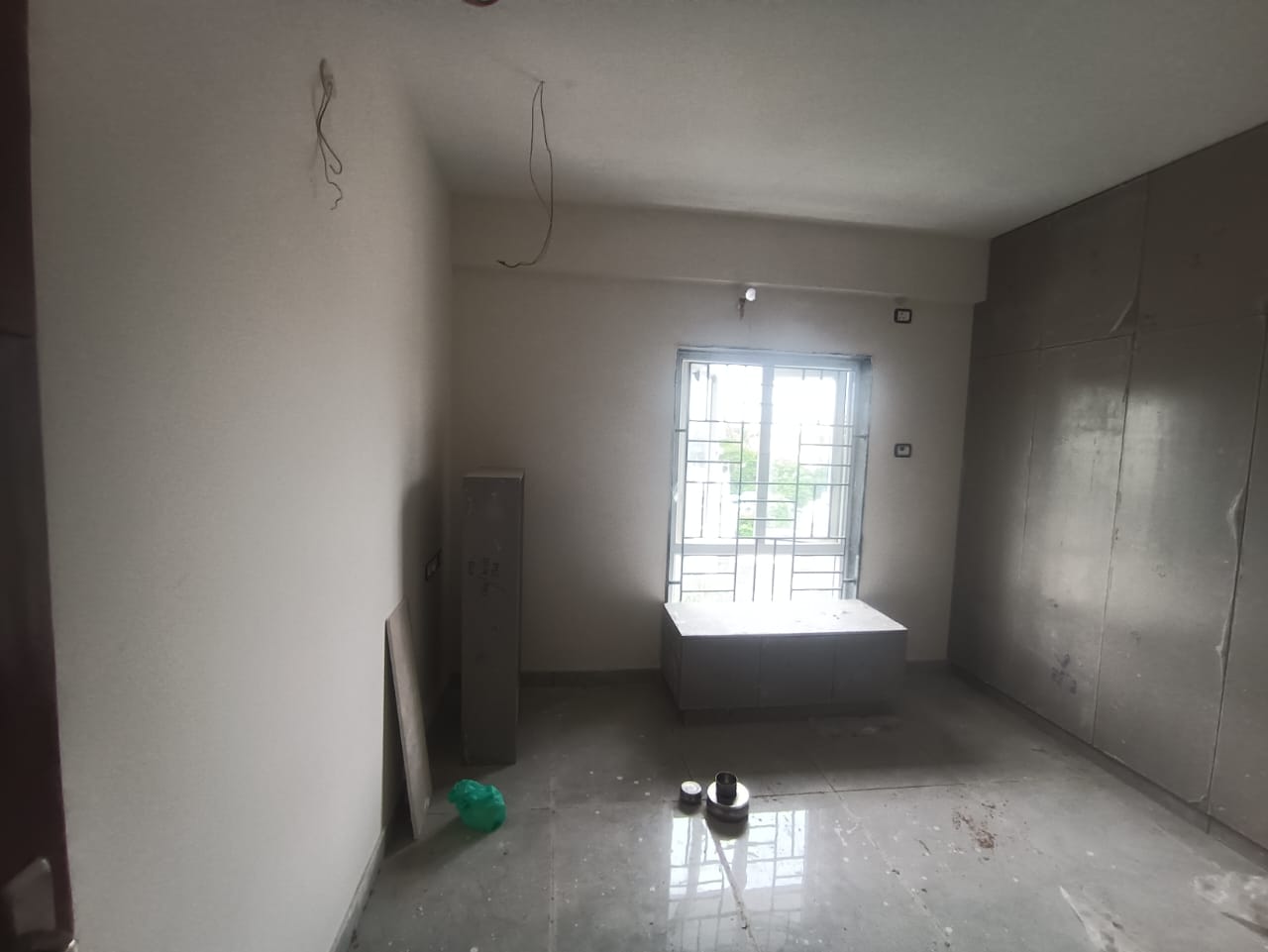

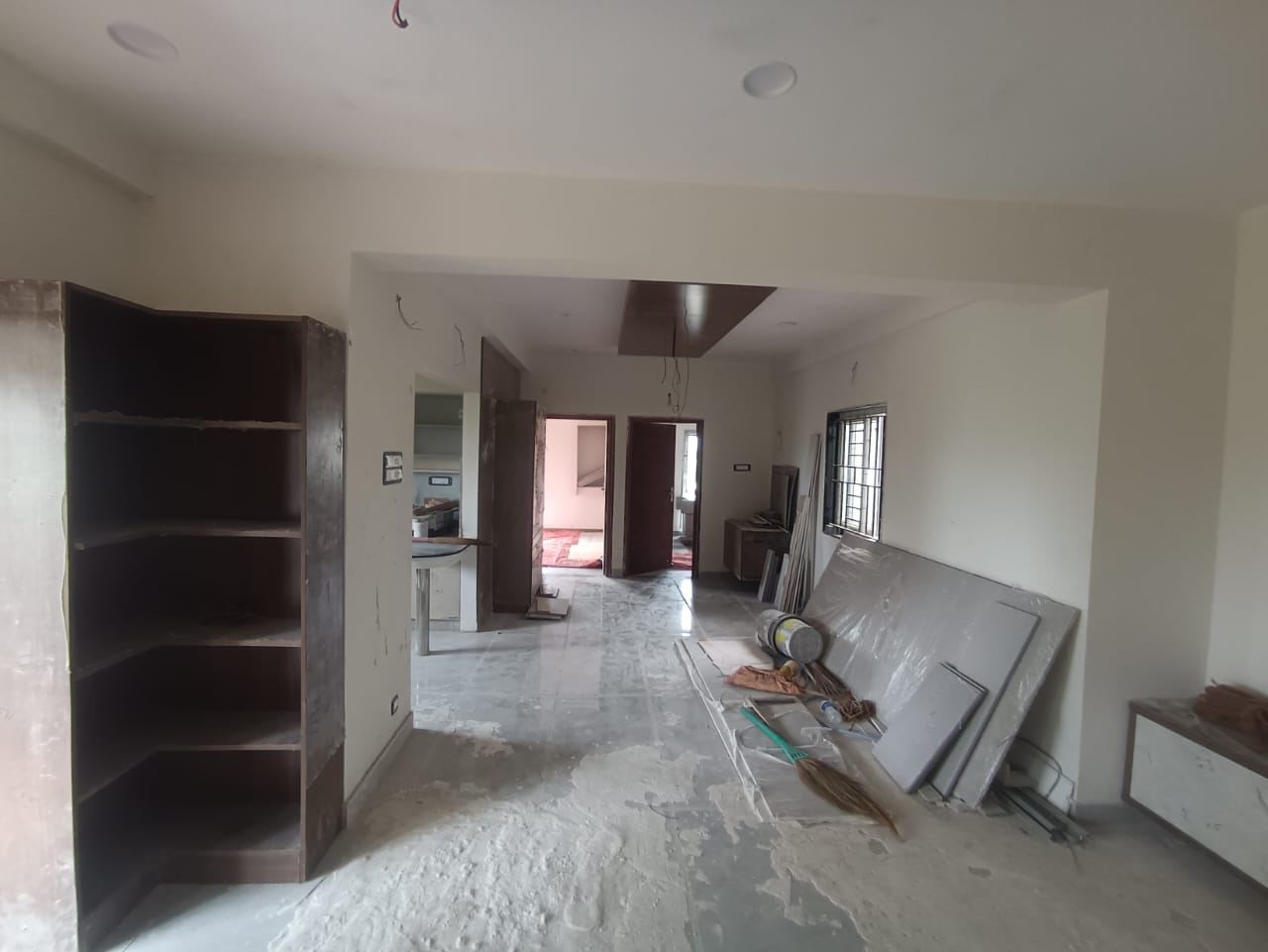

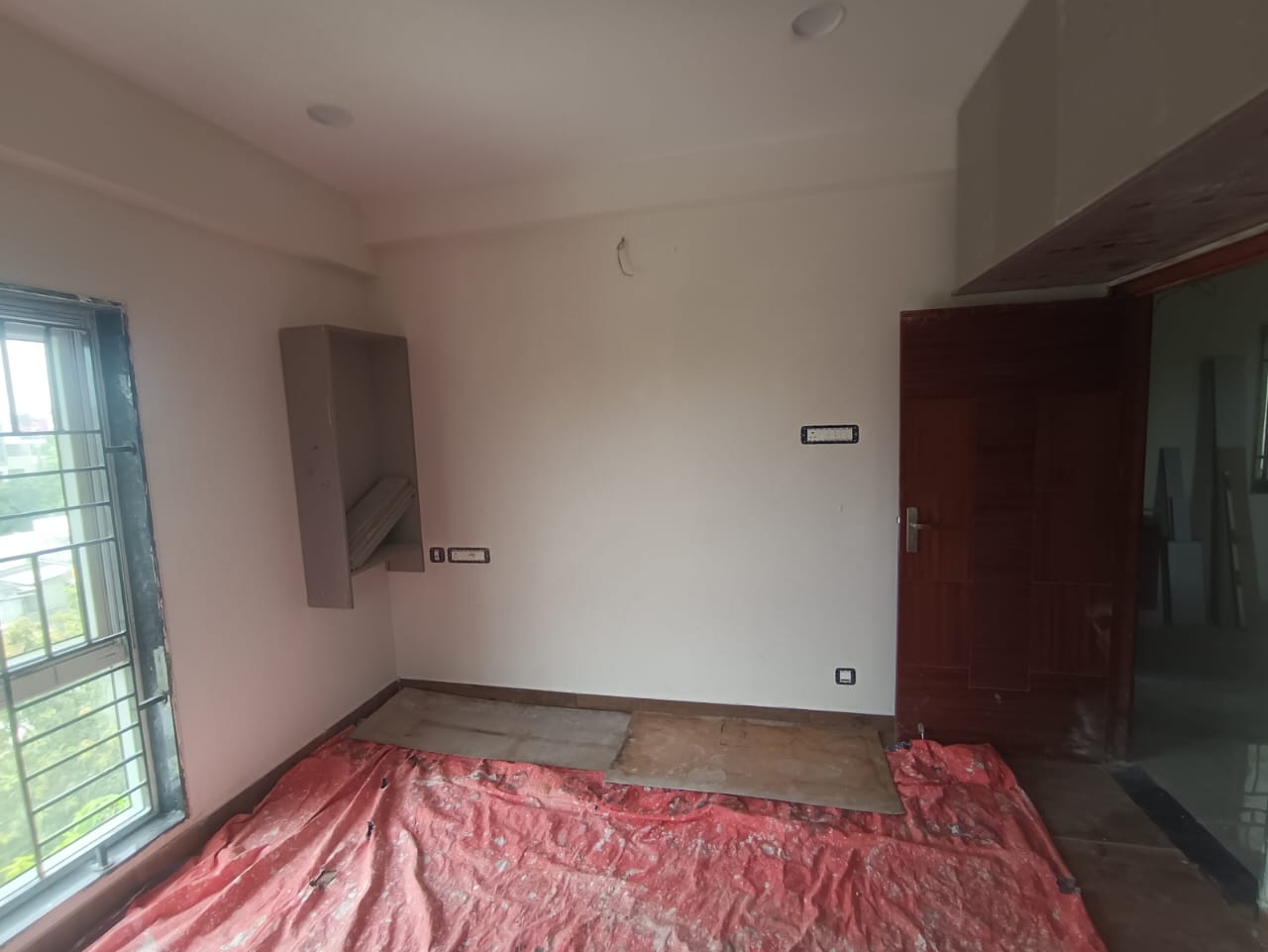

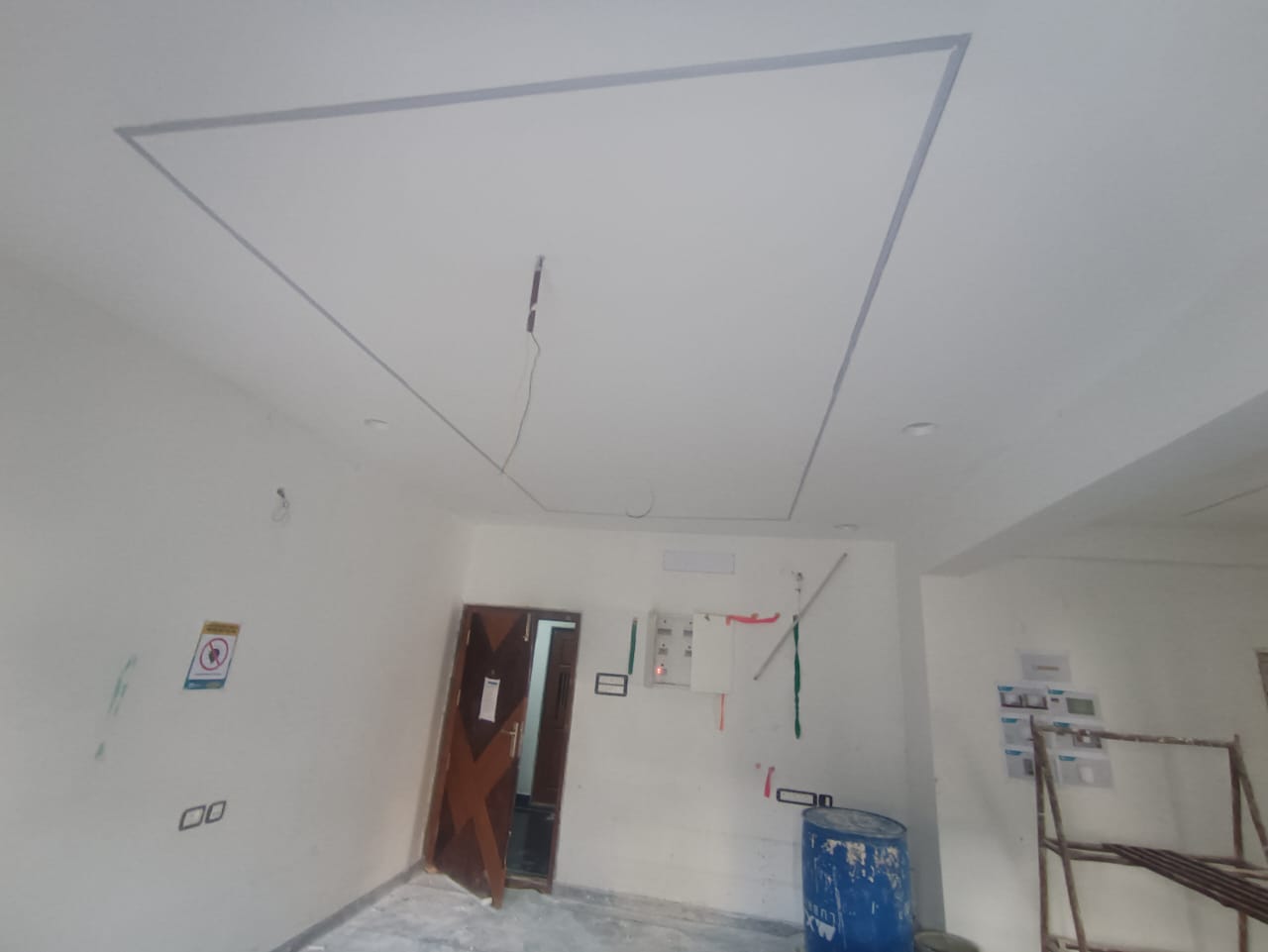

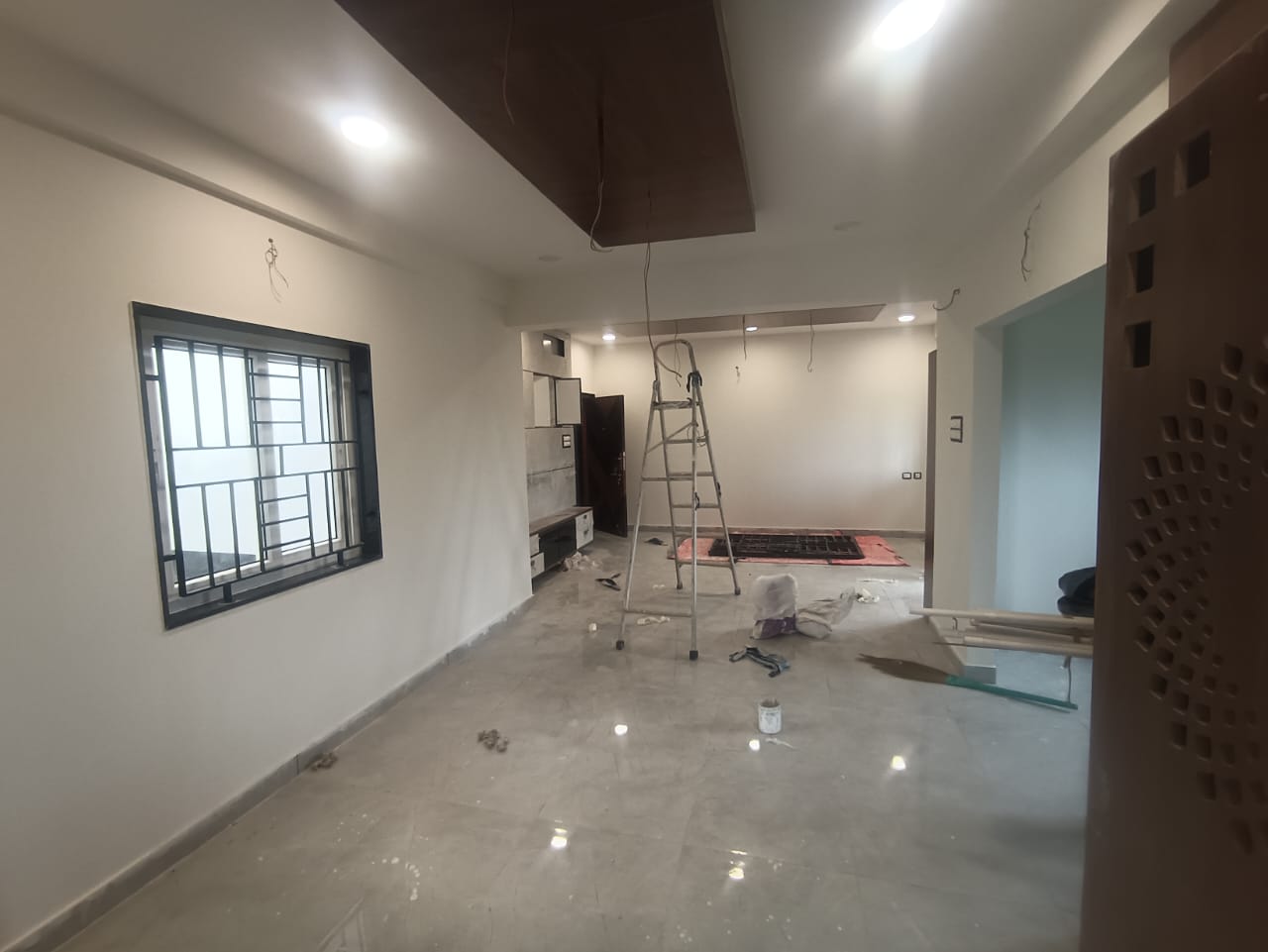

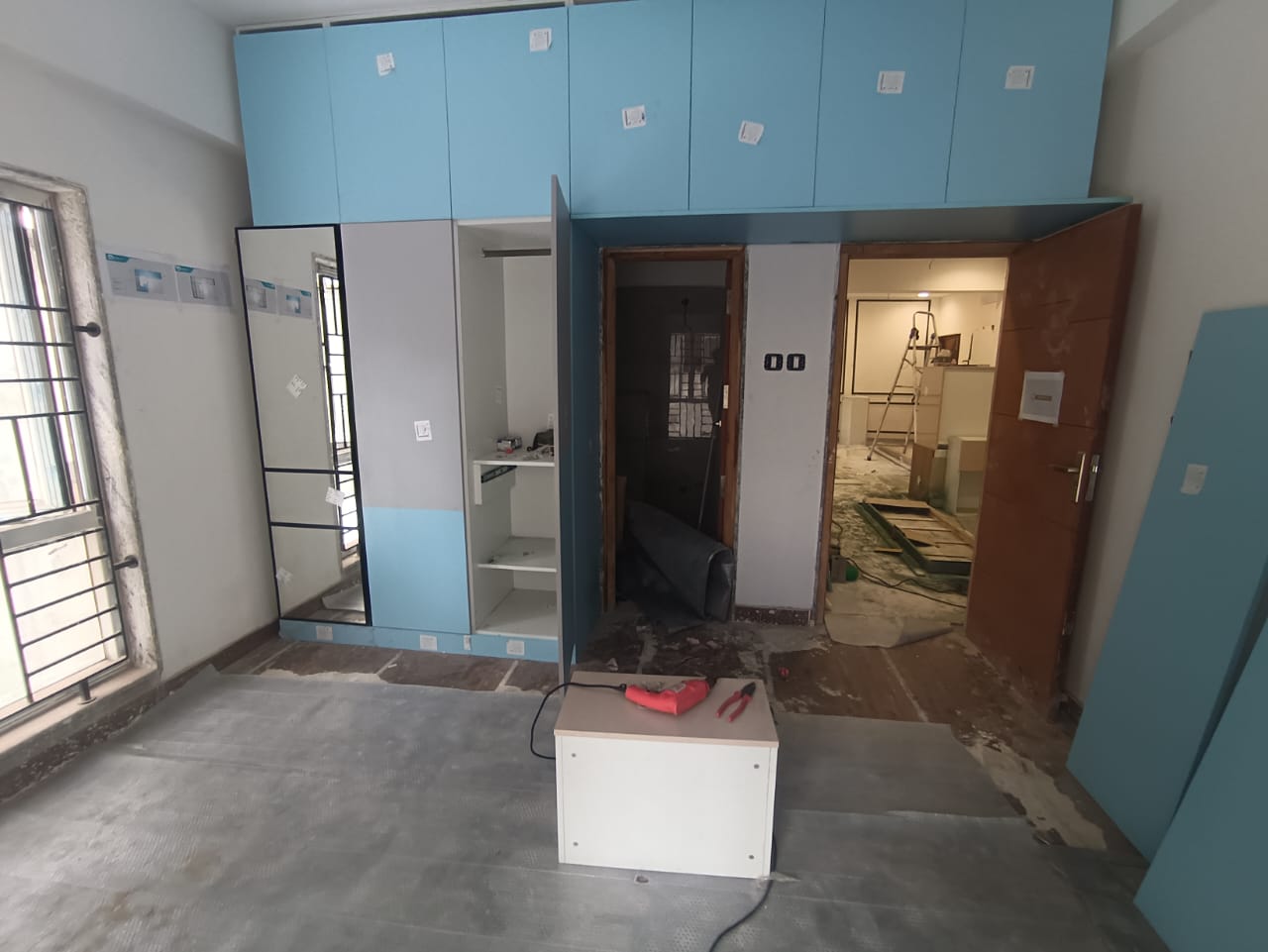

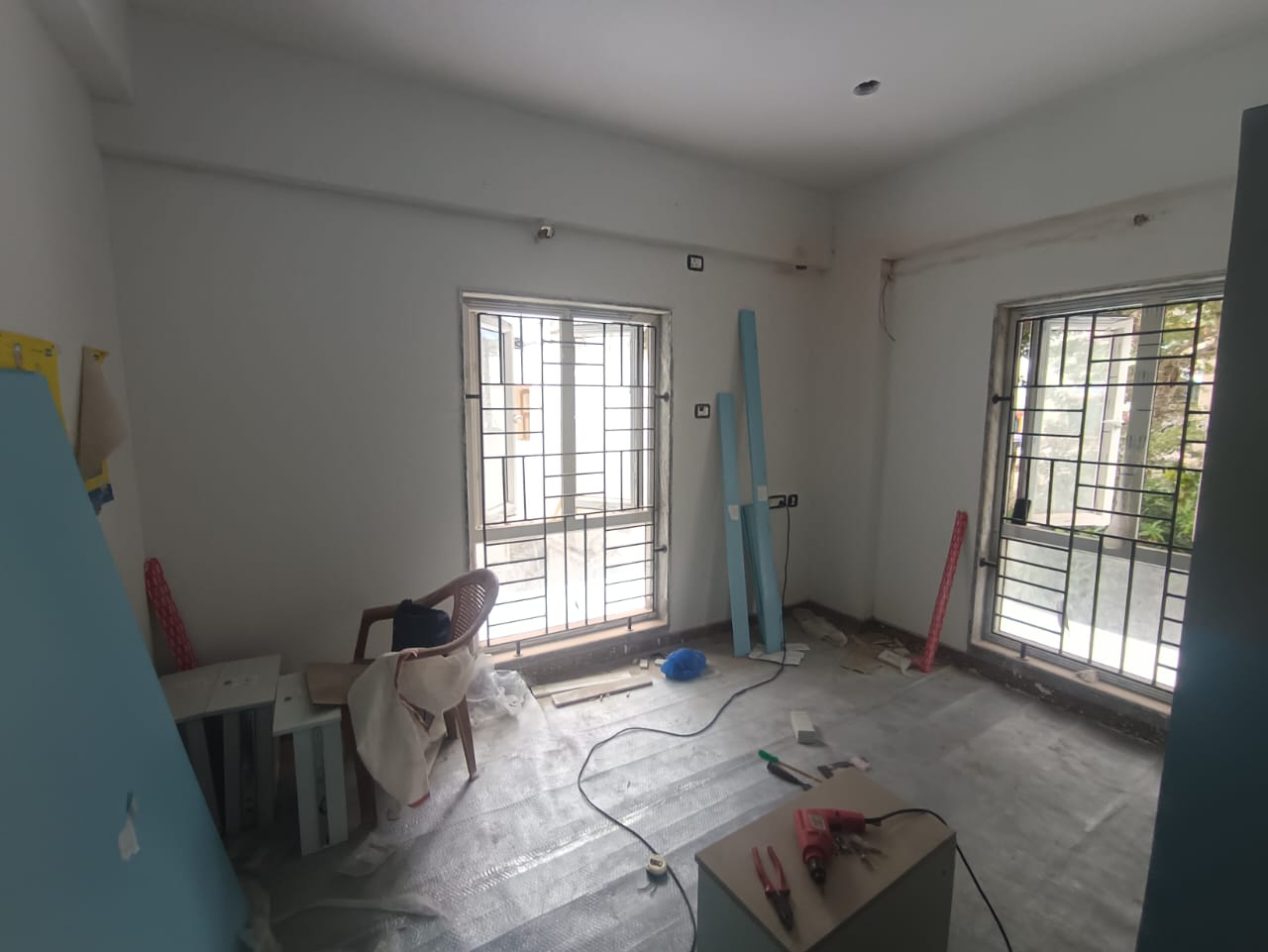

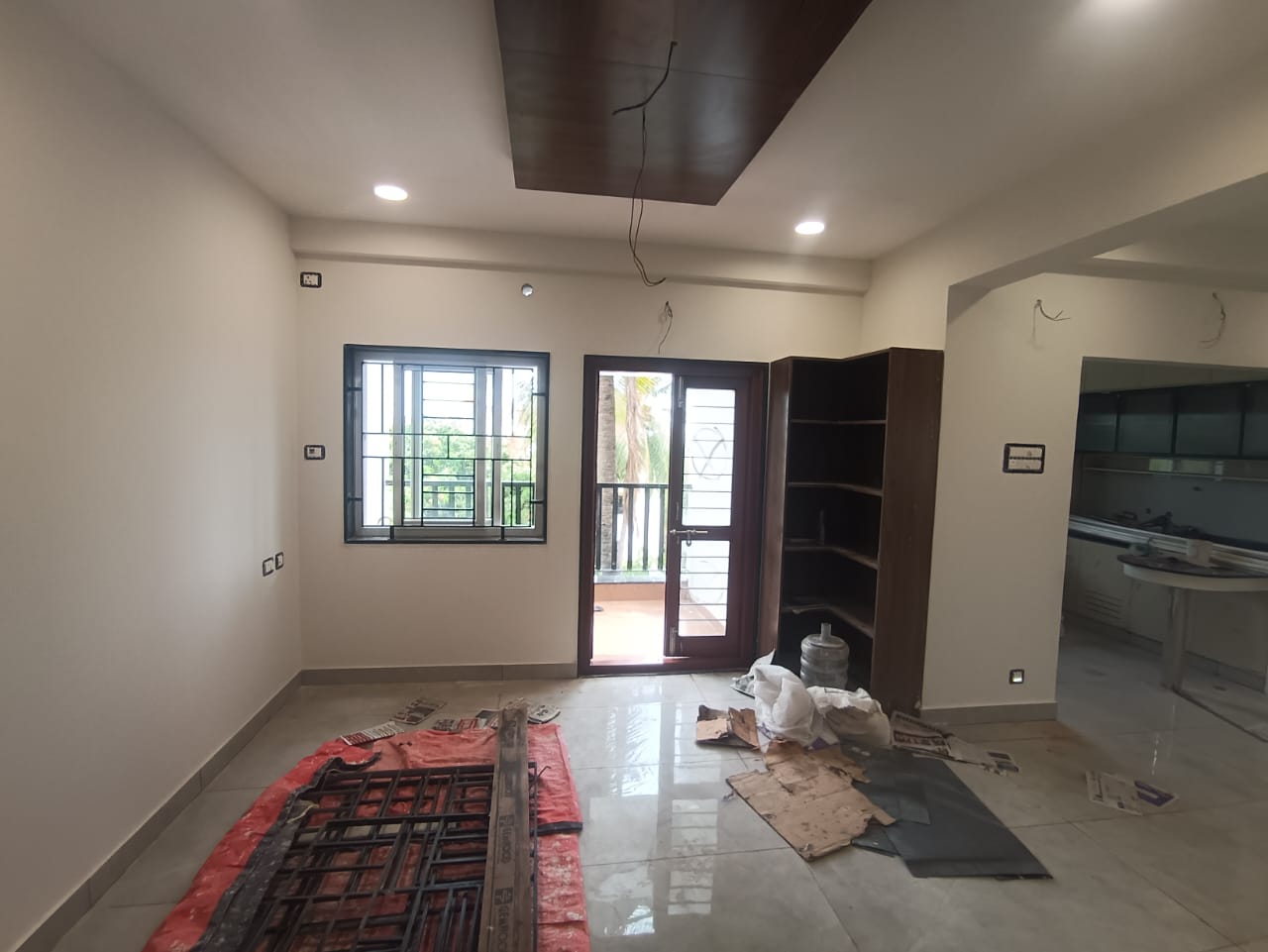

Project Update Images

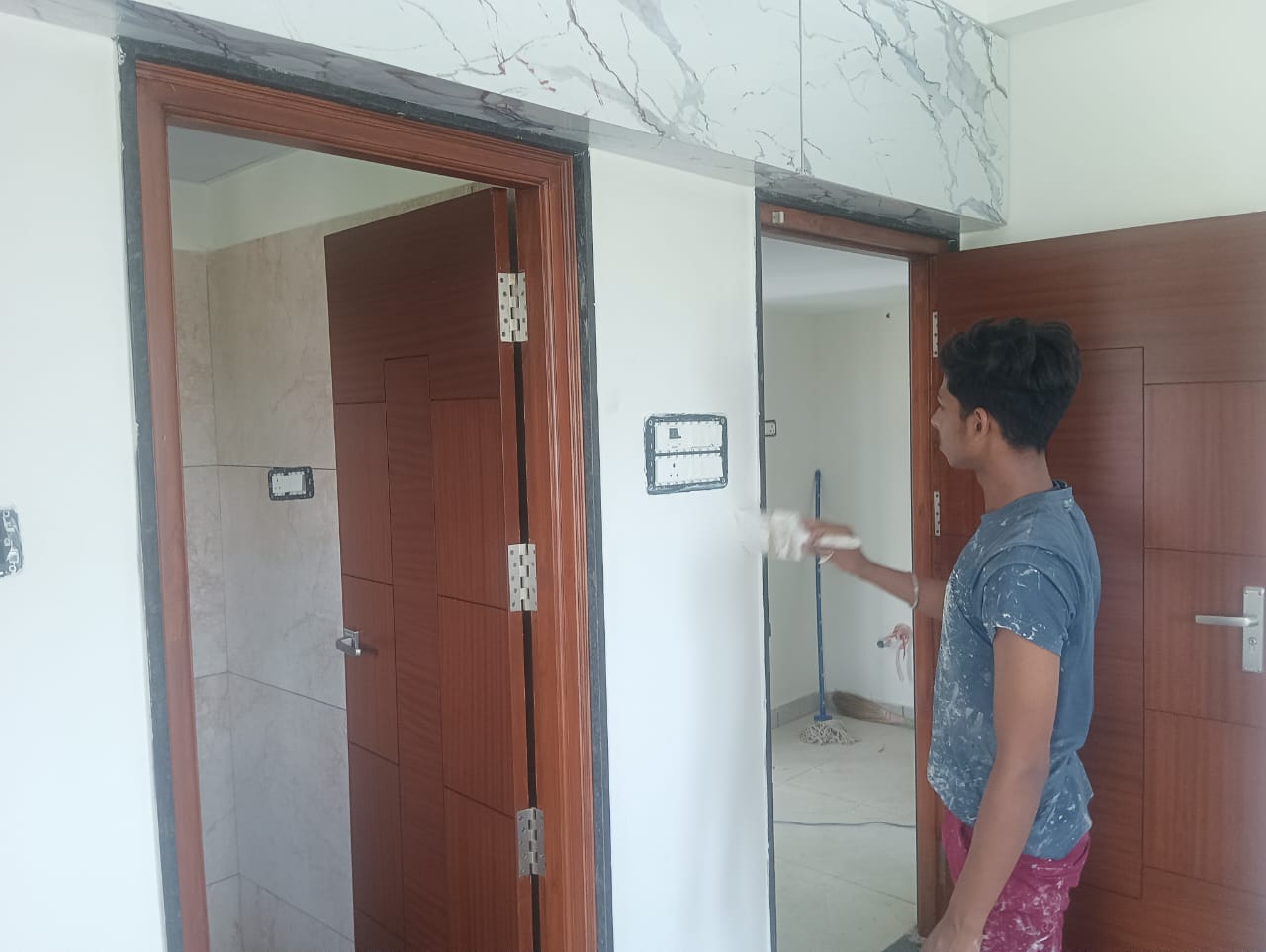

  • 2nd and 3rd floor inner wall primer coat painting work is completed.
  • 2nd, 3rd and 4th floor general flooring and toilet wall tiles laying work is completed. (Except 3rd floor Hold flat)

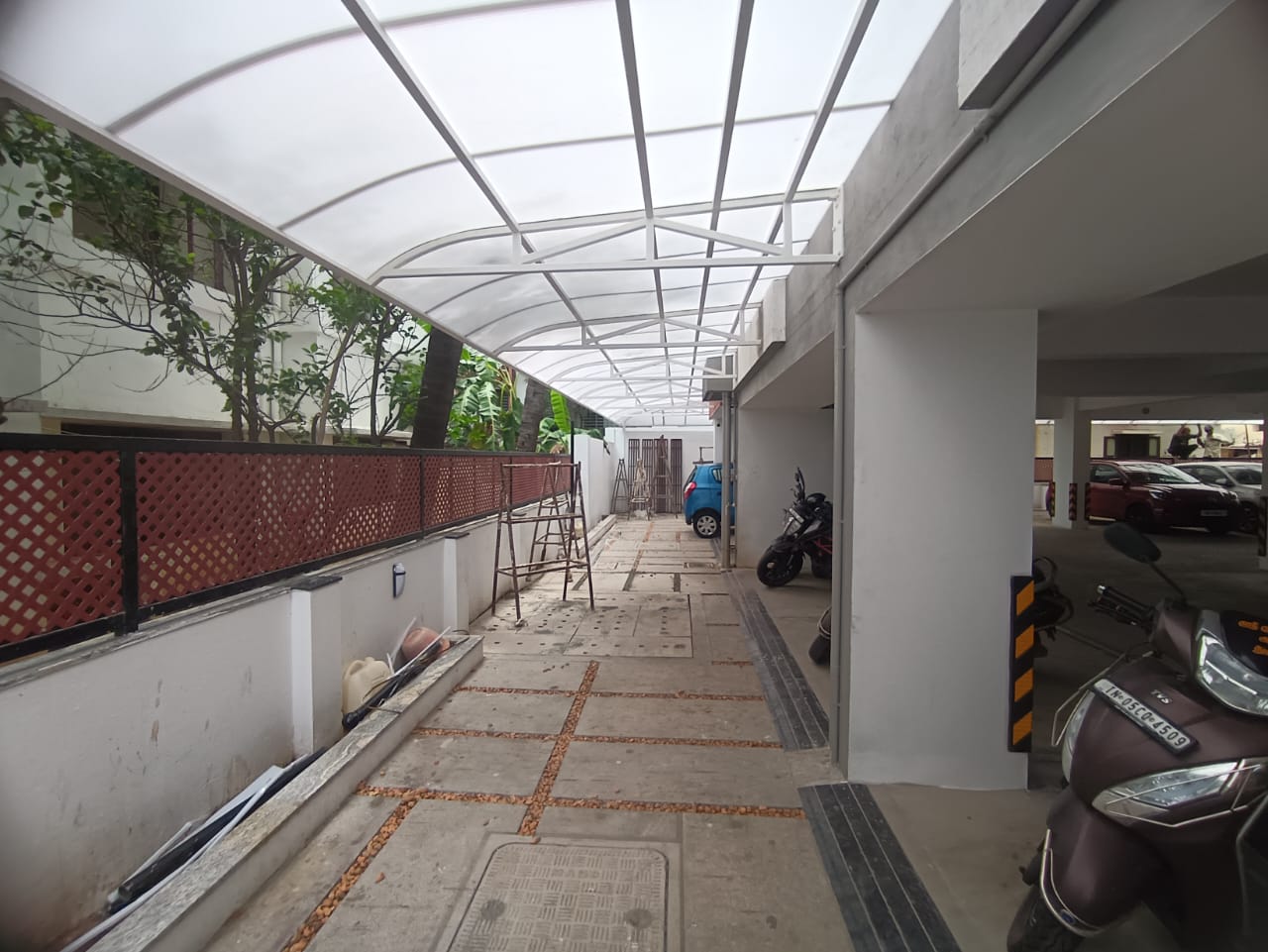

  • Lift erection work is in progress. (60% completed)
  • Lift wall cladding work is in progress. (80% completed)

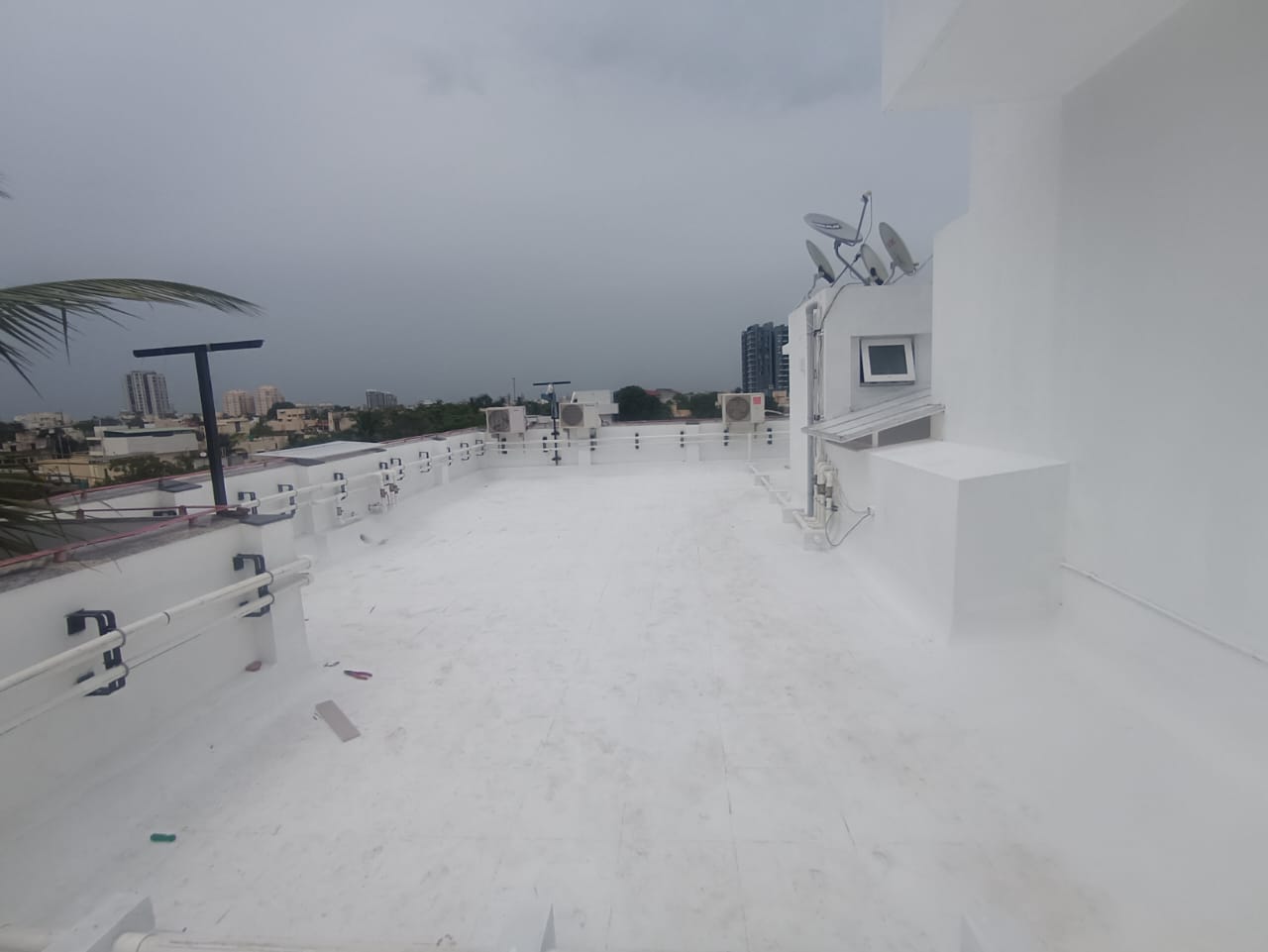

  • Terrace weathering course work is completed
  • Elevation tile laying work is in progress. (25% completed)

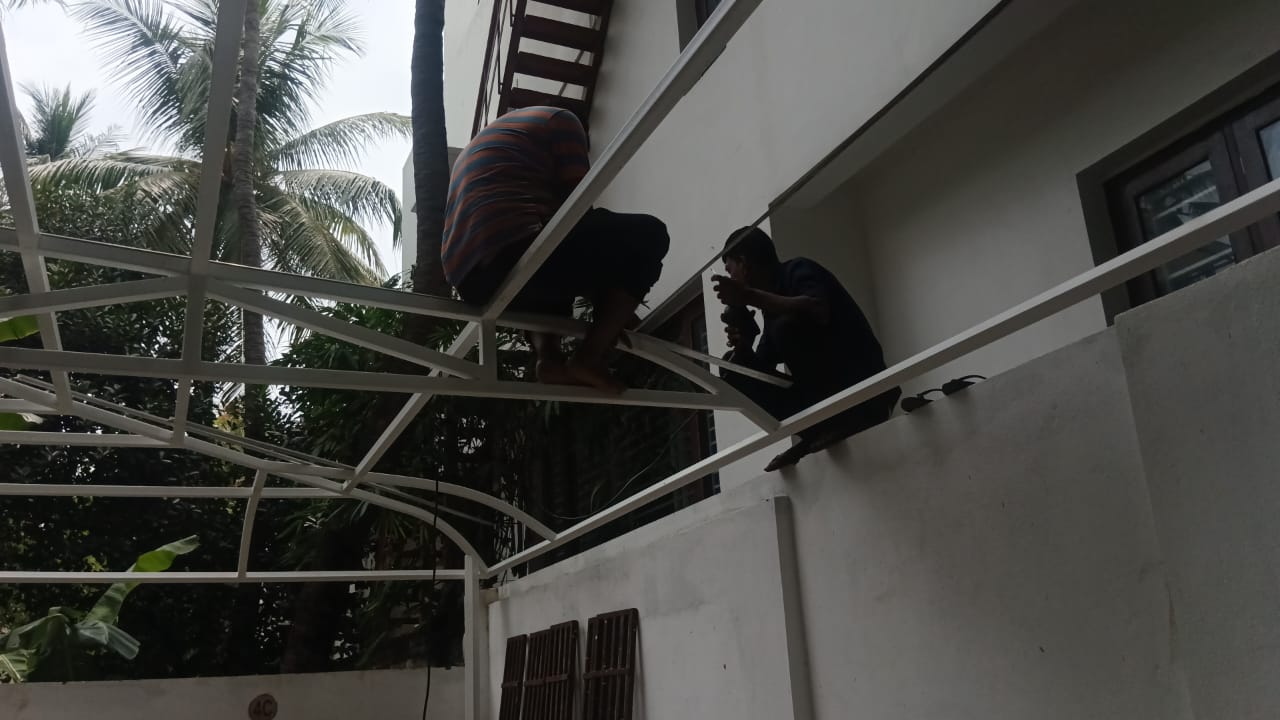

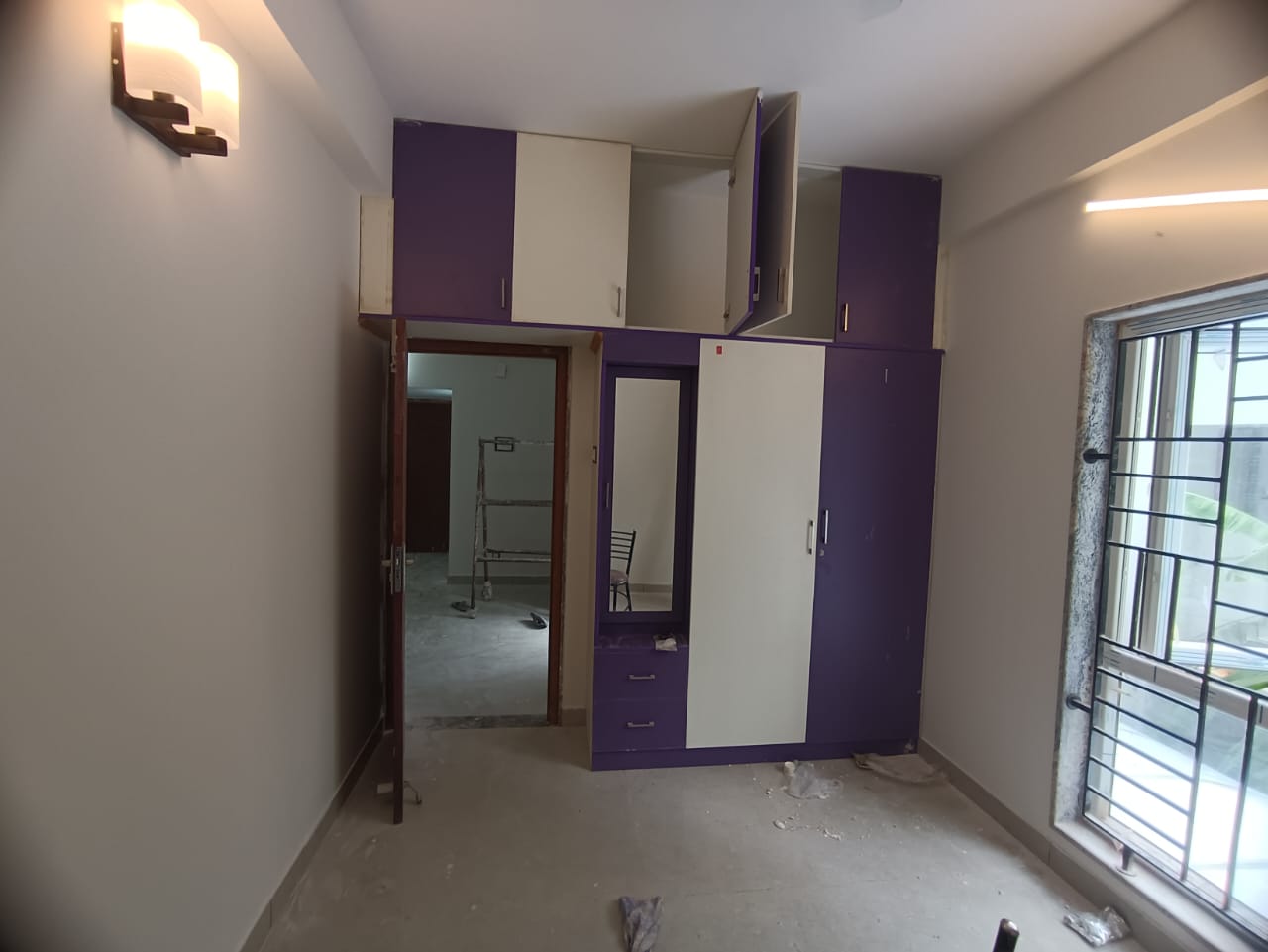

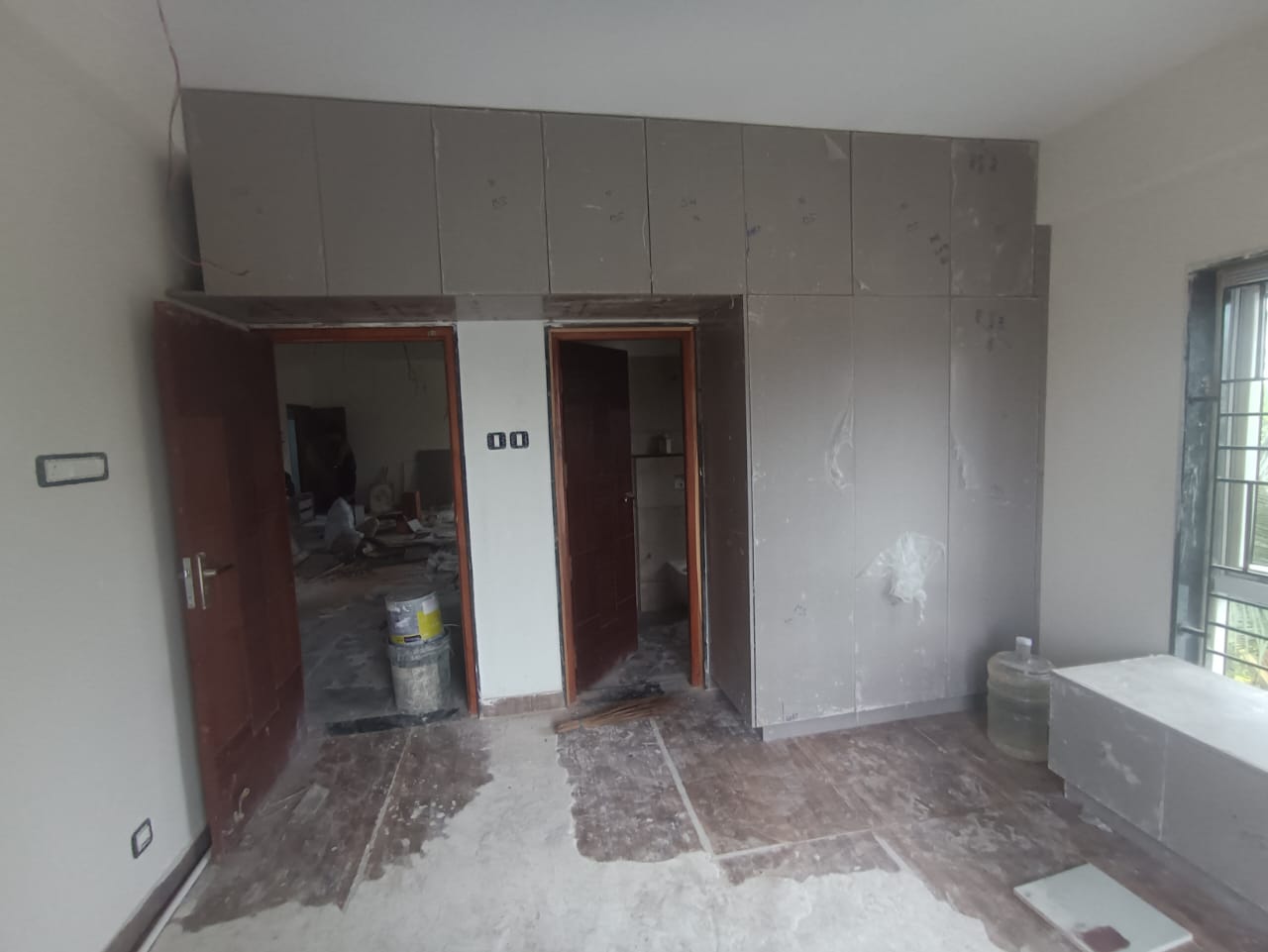

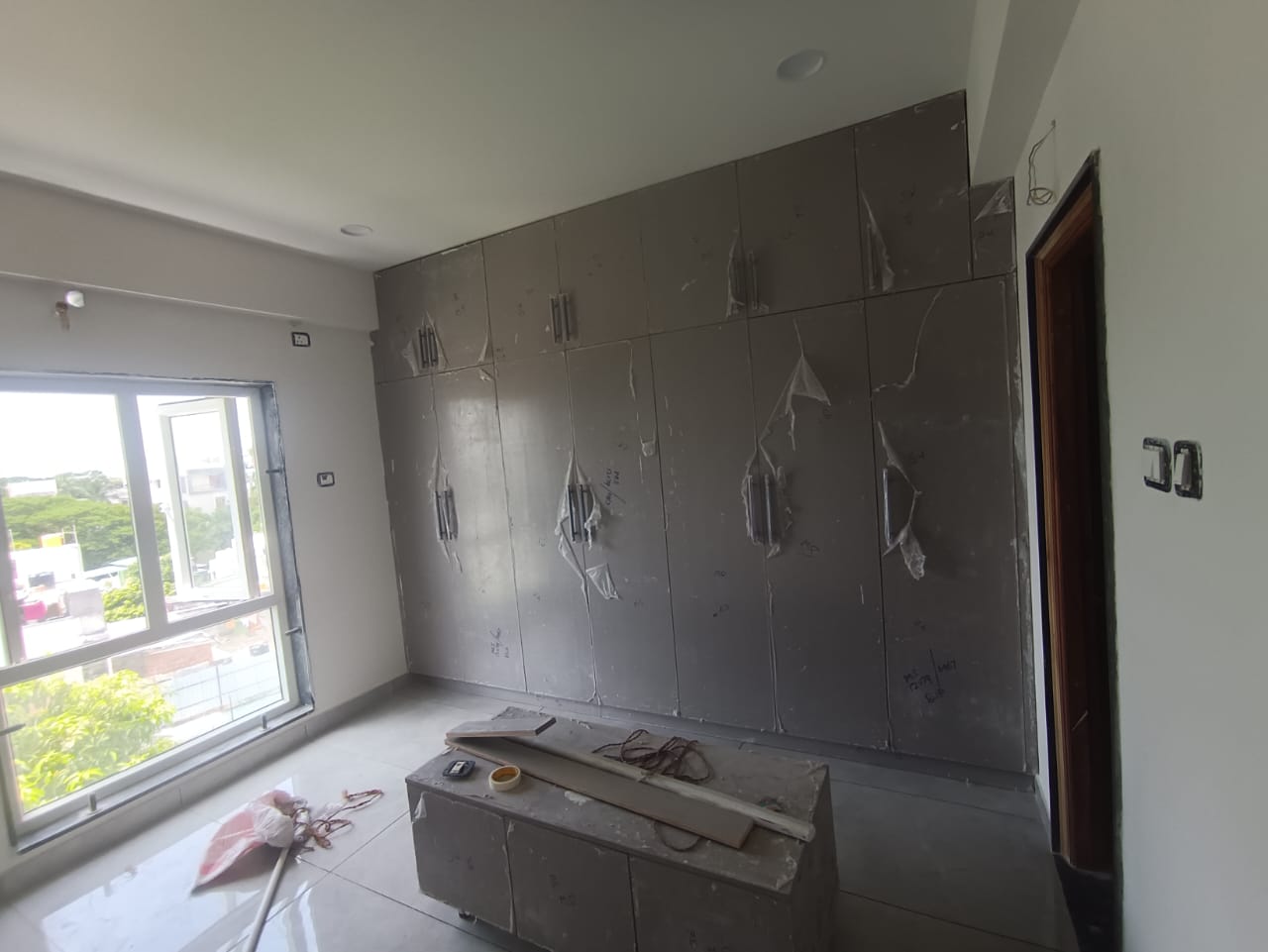

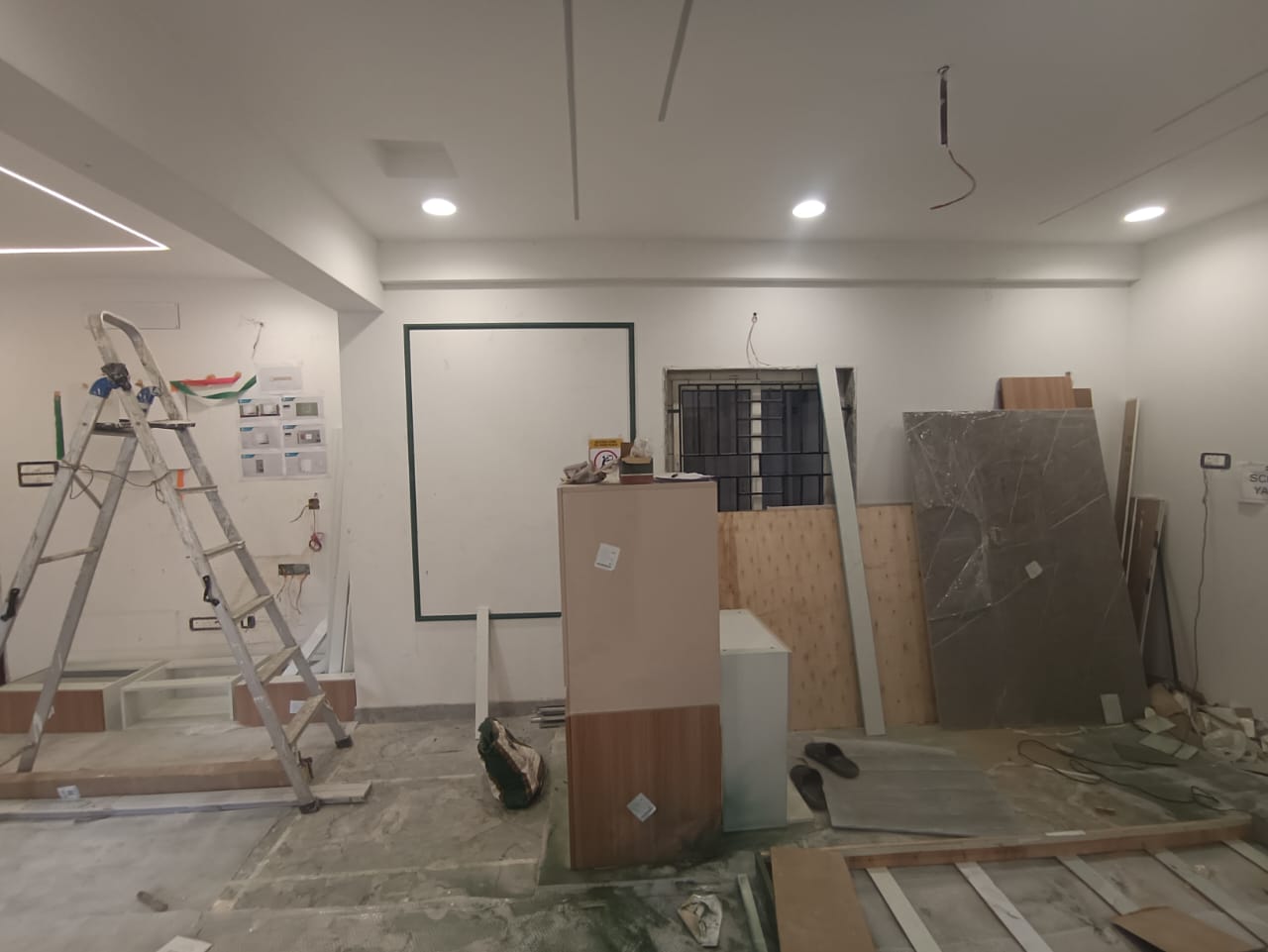

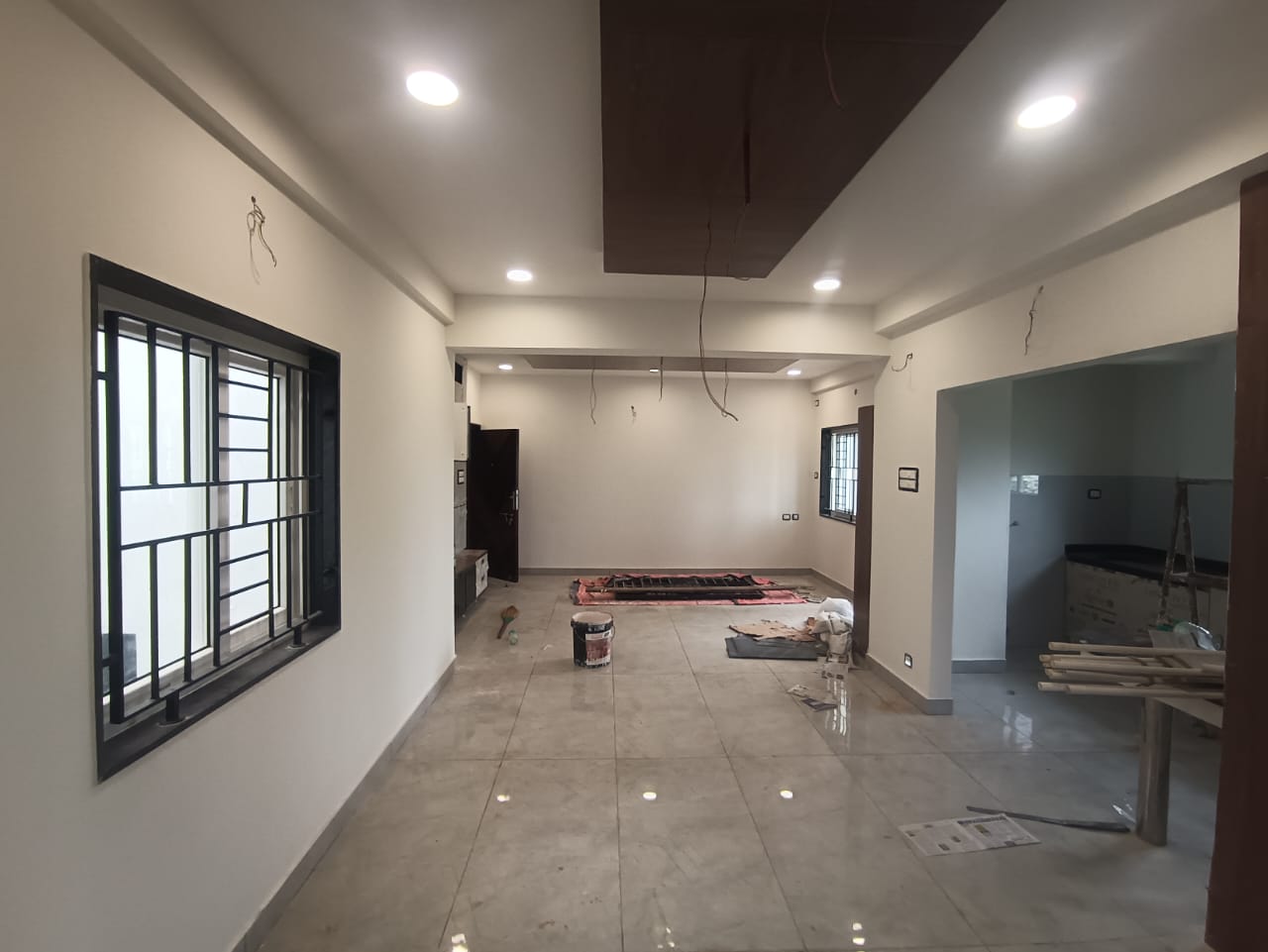

  • Model flat work is in progress (Flat 1A & 2D)
  • 2nd and 3rd floor inner wall primer coat painting work is completed.
  • 2nd,3rd and 5th floor general flooring and toilet wall tiles laying work is in progress.
  • Lift erection work is in progress. (70% completed)
  • Lift wall cladding work is completed.
  • Elevation tile laying work is in progress. (70% completed)

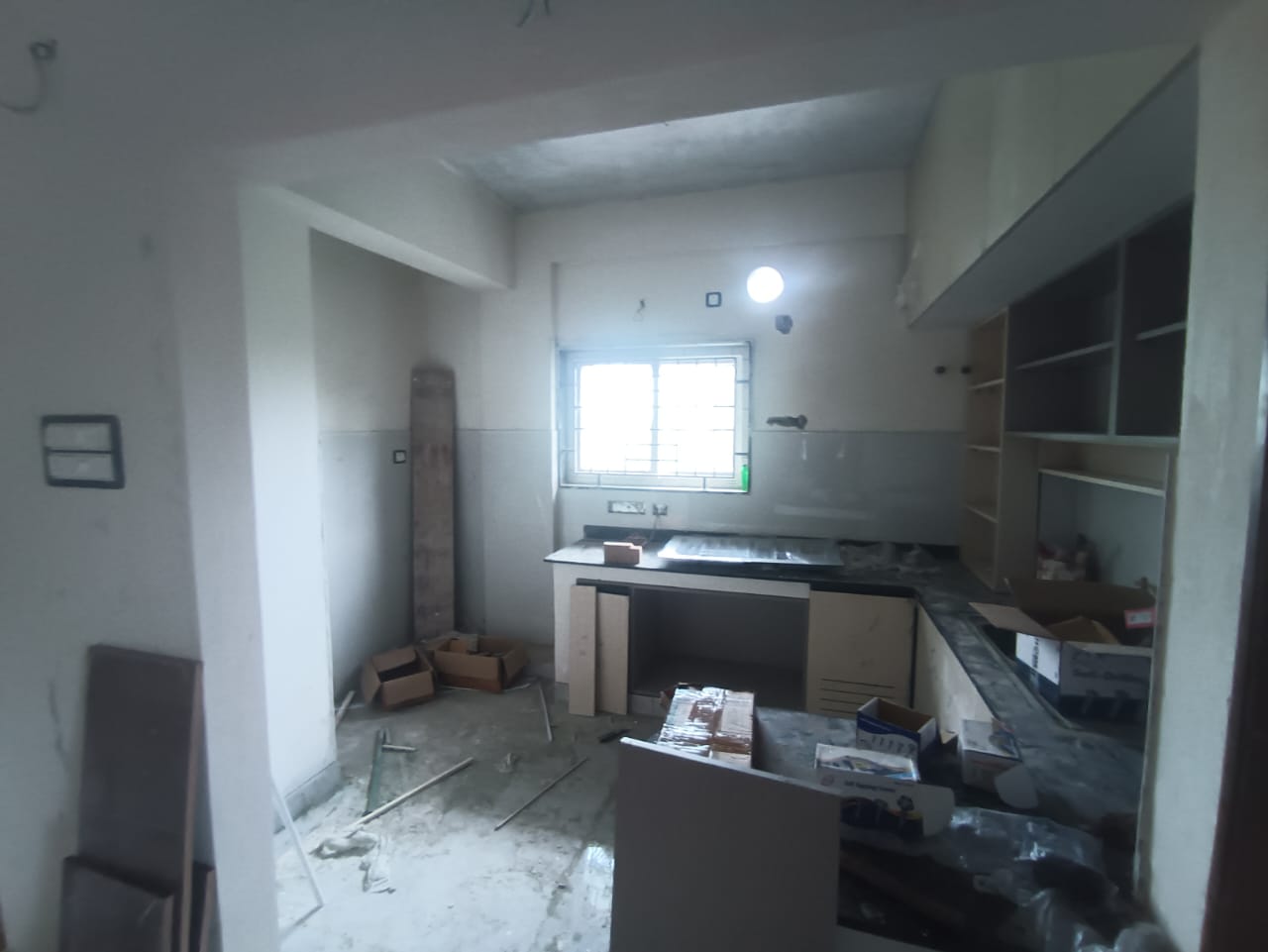

  • Duct plumbing work is in progress.

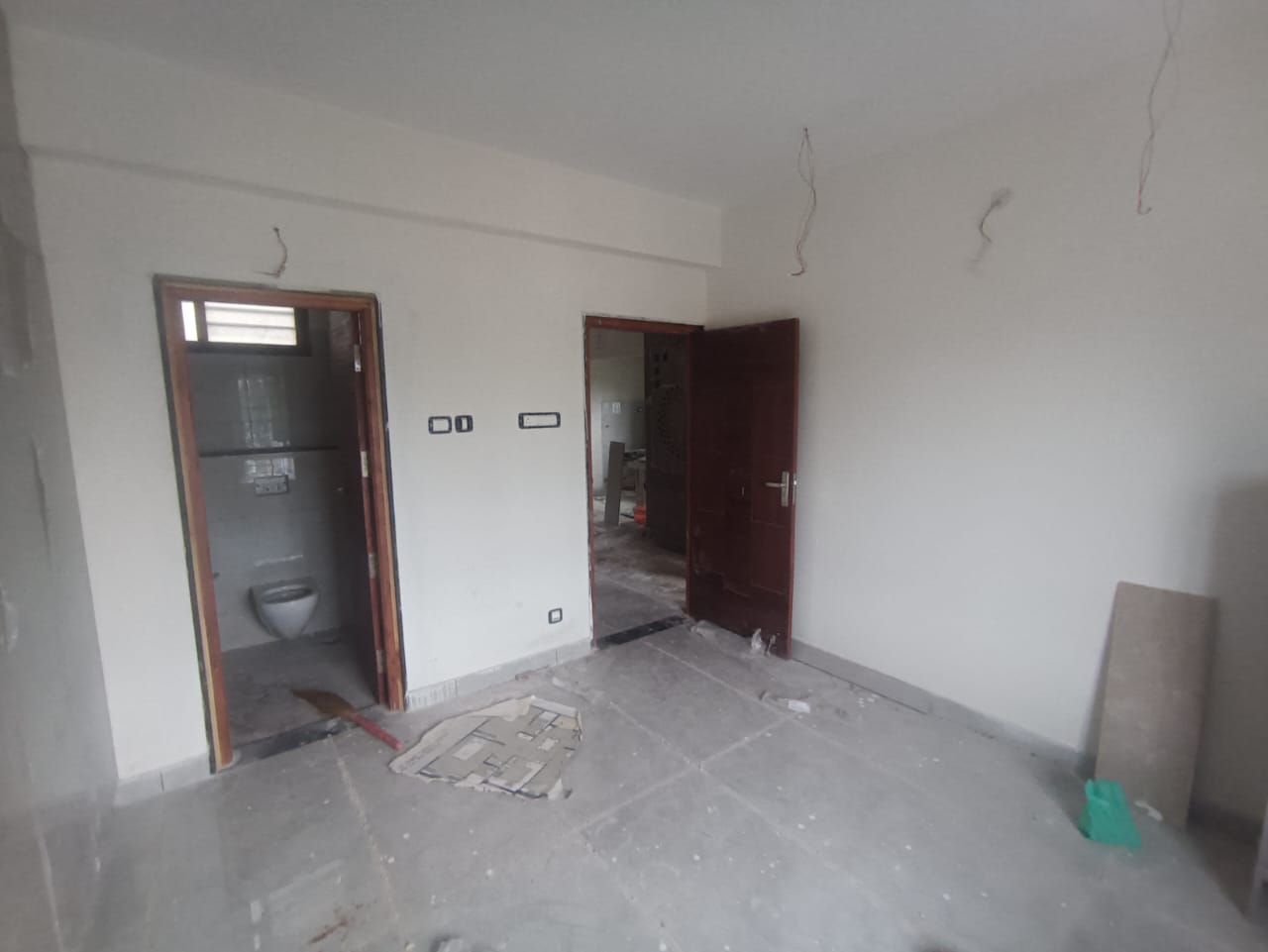

  • 2nd and 3rd floor general flooring and toilet wall tiles laying work is in progress.(70% completed)
  • 3rd floor inner plastering work is in progress. (70% completed)
  • Lift erection work is in progress. (70% completed)
  • Elevation tile laying work is completed.
  • Duct plumbing work is completed.

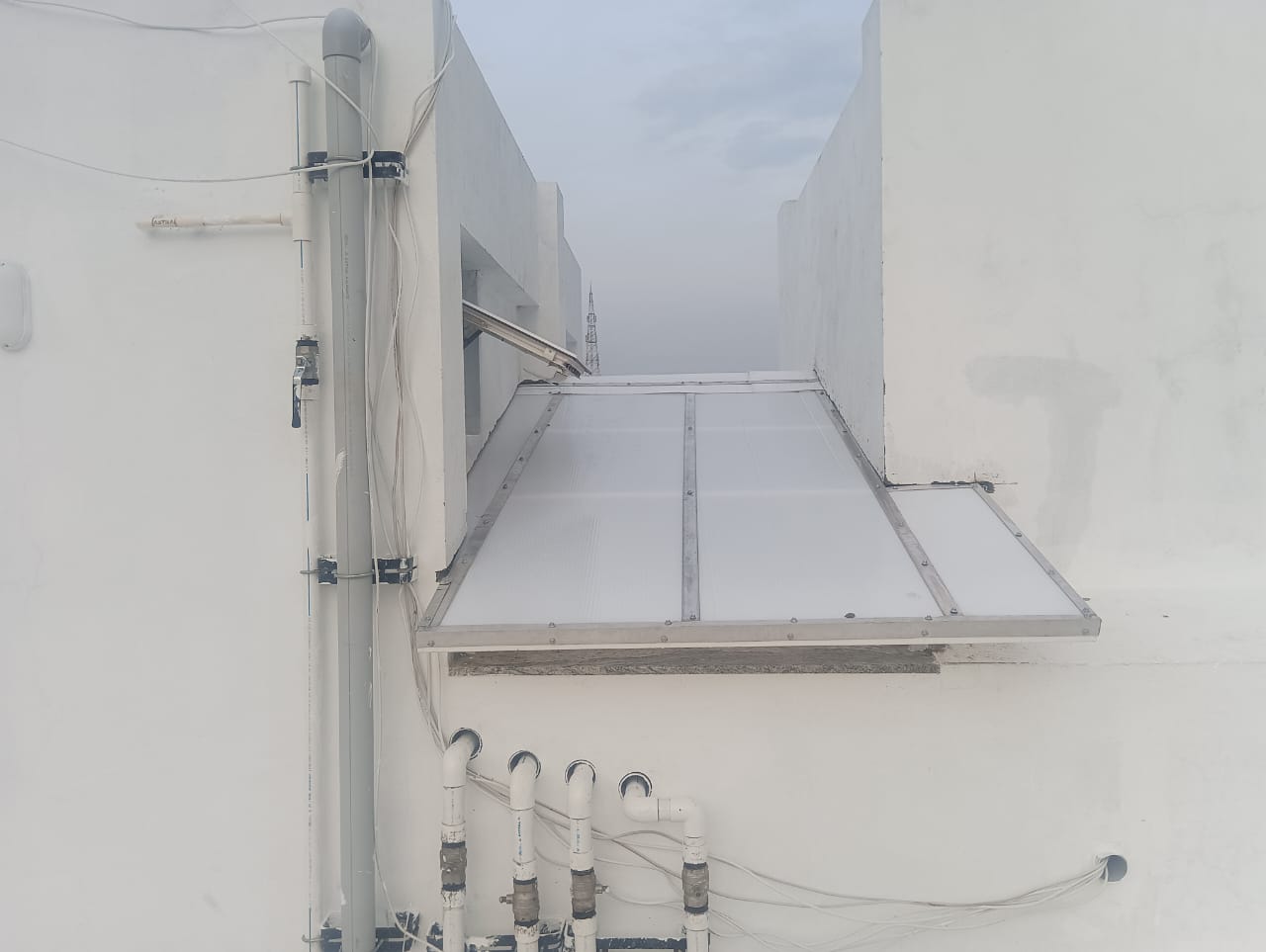

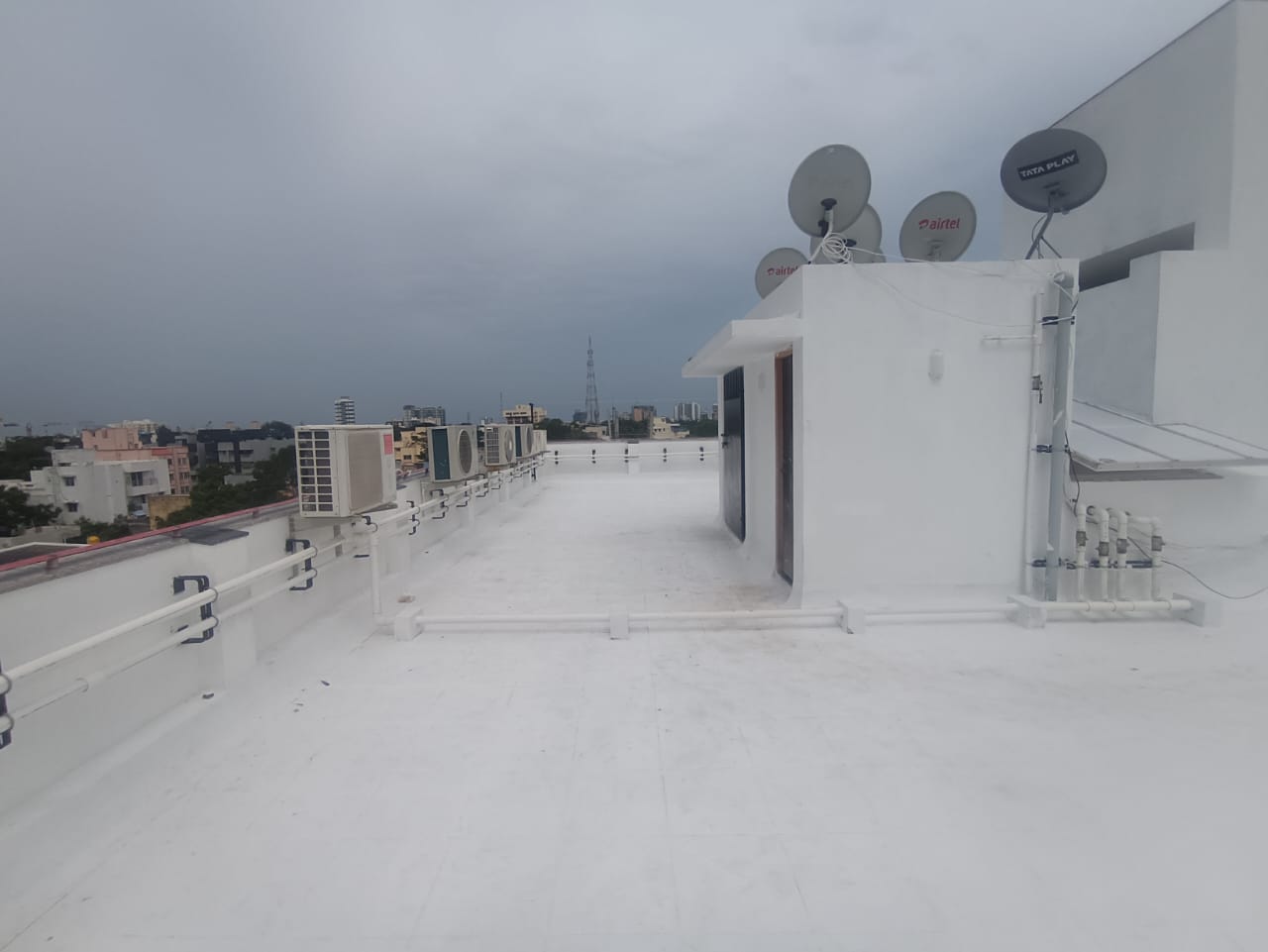

  • Terrace ring main work is in progress.
  • Model flat work is in progress (Flat 1A & 2D)
  • 3rd floor general flooring and toilet wall tiles laying work is in progress. (70% completed).
  • 2nd and 5th floor inner primer coat painting work is in progress.
  • Lift erection work is in progress. (80% completed)
  • Elevation tile laying work is completed.
  • Duct plumbing work is completed.
  • Terrace ring main work is in progress.

  • Model flat work is completed (Flat 1A & 2D)

Property Location

Let your dreams be our

next Project!
